Permit Application Status

PRCOM20220590

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20220590
Building Permit - Commercial
Certificate of Occupancy
NEW COMMERCIAL
NEW RESTAURANT WITH DRIVE-THRU
02/16/2022
06/03/2022
11/01/2022
03/07/2023
Locations
Contacts
Parkway C&A LP, Address:1000 CIVIC CIRCLE, Phone:(469) 322-3763
thurlo@mobettahs.com, Address:thurlo@mobettahs.com, Phone:(801) 380-4092
CITY WIDE SHEET METAL, INC, Address:2820 G ROE LN, Phone:(913) 871-7464
SMART POWER SERVICES, Address:1151 SE CENTURY DR, Phone:(816) 366-0385
PLUMBING BY FISHER INC, Address:9875 KILL CREEK RD, Phone:(913) 583-1971
Babcock Design, Address:52 Exchange Place, Phone:(801) 433-4309
Reviews
Review Type Outcome Est. Completion Date Completed
Building Plan Review Approved with Conditions 06/22/2022 06/20/2022
Joe Frogge
Health Dept Inspection
Corrective Action Required
06/15/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 4/29/22 - acknowledged in letter
Engineered truss package
Corrective Action Required
06/15/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide truss package or request deferral. 4/29/22 - deferred per request
Building Plan Review Approved with Conditions 05/17/2022 05/16/2022
Joe Frogge
Health Dept Review
Resolved
05/16/2022

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes. 4/29/22 - acknowledged in letter
Health Dept Inspection
Corrective Action Required
05/10/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 4/29/22 - acknowledged in letter
Engineered truss package
Corrective Action Required
05/10/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide truss package or request deferral. 4/29/22 - deferred per request
IMC 507.2.6 Clearances for Type I hood
Resolved
05/10/2022

2018 IMC 507.2.6 Clearances for Type I hood. A Type I hood shall be installed with a clearance to combustibles of not less than 18”. Exceptions: 1. Clearance shall not be required from gypsum wallboard or ½ inch or thicker cementitious wallboard attached to noncombustible structures provided that a smooth, cleanable, nonabsorbent and noncombustible material is installed between the hood and the gypsum or cementitious wallboard over an area extending not less than 18 inches in all directions from the hood. 2. Type I hoods listed and labeled for clearances less than 18 inches in accordance with UL 710 shall be installed with the clearances specified by such listings. Action required: Walls adjacent to and within 18" of Type I hood must be non-combustible. (Including exterior wall at side of hood) Modify design to comply. 4/29/22 - wood studs still present. modify design
Health Department Review Approved 05/16/2022
Joe Frogge
Fire Plan Review Approved with Conditions 05/17/2022 05/10/2022
Joe Frogge
Installation acceptance testing
Corrective Action Required
05/10/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational purposes) (Call 816-969-1300 to schedule hood trip test)
Emergency power for illumination
Corrective Action Required
05/10/2022

2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits. (Verified at inspection) (Provide External illumination at all exits)
Licensed Contractors Rejected 05/10/2022 05/10/2022
Joe Frogge
LC - MEP Subs
Corrective Action Required
05/10/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 4/29/22 - acknowledged in letter
LC - General Contractor
Corrective Action Required
05/10/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact which is where inspection reports will be sent. 4/29/22 - acknowledged in letter
Fire Plan Review Approved with Conditions 05/04/2022 05/05/2022
Joe Frogge
Installation acceptance testing
Corrective Action Required
04/27/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational purposes) (Call 816-969-1300 to schedule hood trip test)
Emergency power for illumination
Corrective Action Required
04/27/2022

2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits. (Verified at inspection) (Provide External illumination at all exits)
Building Plan Review Rejected 05/04/2022 04/29/2022
Joe Frogge
Health Dept Review
Corrective Action Required
04/27/2022

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes. 4/29/22 - acknowledged in letter
Health Dept Inspection
Corrective Action Required
04/27/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 4/29/22 - acknowledged in letter
Engineered truss package
Corrective Action Required
04/27/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide truss package or request deferral. 4/29/22 - deferred per request
IMC 507.2.6 Clearances for Type I hood
Corrective Action Required
04/27/2022

2018 IMC 507.2.6 Clearances for Type I hood. A Type I hood shall be installed with a clearance to combustibles of not less than 18”. Exceptions: 1. Clearance shall not be required from gypsum wallboard or ½ inch or thicker cementitious wallboard attached to noncombustible structures provided that a smooth, cleanable, nonabsorbent and noncombustible material is installed between the hood and the gypsum or cementitious wallboard over an area extending not less than 18 inches in all directions from the hood. 2. Type I hoods listed and labeled for clearances less than 18 inches in accordance with UL 710 shall be installed with the clearances specified by such listings. Action required: Walls adjacent to and within 18" of Type I hood must be non-combustible. (Including exterior wall at side of hood) Modify design to comply. 4/29/22 - wood studs still present. modify design
IBC 1803.1 General - geotech
Resolved
04/29/2022

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity of 2,500psf.
Miscellaneous Correction
Resolved
04/29/2022

Grease interceptor design not found. Action required: Provide complete design for grease interceptor. (location shown on civil plans but refers to this architectural set for design)
NEC Article 210.63 Heating, air-conditioning and refrigeration outlet
Resolved
04/29/2022

2017 NEC Article 210.63 Heating, Air-Conditioning, and Refrigeration Equipment Outlet. A 125-volt, single-phase, 15- or 20-ampere-rated receptacle outlet shall be installed at an accessible location for the servicing of heating, air-conditioning, and refrigeration equipment. The receptacle shall be located on the same level and within 25 feet of the heating, air-conditioning, and refrigeration equipment. The receptacle outlet shall not be connected to the load side of the equipment disconnecting means. Action required: Provide additional receptacle(s) on roof so all equipment is within 25' of connection.
NEC Article 250.50 Grounding electrode system
Resolved
04/29/2022

2017 NEC Article 250.50 Grounding Electrode System. All Grounding electrodes as described in 250.52(A)(1) through (A)(7) that are present at each building or structure served shall be bonded together to form the grounding electrodes system. Where none of these grounding electrodes exist, one or more of the grounding electrodes specified in 250.52(A)(4) through (A)(8) shall be installed and used. (see code section for exception) Action required: Provide complete diagram for grounding scenario at service disconnect.
Licensed Contractors Rejected 05/04/2022 04/29/2022
Joe Frogge
LC - MEP Subs
Corrective Action Required
04/27/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 4/29/22 - acknowledged in letter
LC - General Contractor
Corrective Action Required
04/27/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact which is where inspection reports will be sent. 4/29/22 - acknowledged in letter
Building Plan Review Rejected 03/03/2022 02/25/2022
Joe Frogge
Health Dept Review
Corrective Action Required
02/25/2022

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes.
Health Dept Inspection
Corrective Action Required
02/25/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes.
Engineered truss package
Corrective Action Required
02/25/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide truss package or request deferral.
IMC 507.2.6 Clearances for Type I hood
Corrective Action Required
02/25/2022

2018 IMC 507.2.6 Clearances for Type I hood. A Type I hood shall be installed with a clearance to combustibles of not less than 18”. Exceptions: 1. Clearance shall not be required from gypsum wallboard or ½ inch or thicker cementitious wallboard attached to noncombustible structures provided that a smooth, cleanable, nonabsorbent and noncombustible material is installed between the hood and the gypsum or cementitious wallboard over an area extending not less than 18 inches in all directions from the hood. 2. Type I hoods listed and labeled for clearances less than 18 inches in accordance with UL 710 shall be installed with the clearances specified by such listings. Action required: Walls adjacent to and within 18" of Type I hood must be non-combustible. (Including exterior wall at side of hood) Modify design to comply.
IBC 1803.1 General - geotech
Corrective Action Required
02/25/2022

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity of 2,500psf.
Miscellaneous Correction
Corrective Action Required
02/25/2022

Grease interceptor design not found. Action required: Provide complete design for grease interceptor. (location shown on civil plans but refers to this architectural set for design)
NEC Article 210.63 Heating, air-conditioning and refrigeration outlet
Corrective Action Required
02/25/2022

2017 NEC Article 210.63 Heating, Air-Conditioning, and Refrigeration Equipment Outlet. A 125-volt, single-phase, 15- or 20-ampere-rated receptacle outlet shall be installed at an accessible location for the servicing of heating, air-conditioning, and refrigeration equipment. The receptacle shall be located on the same level and within 25 feet of the heating, air-conditioning, and refrigeration equipment. The receptacle outlet shall not be connected to the load side of the equipment disconnecting means. Action required: Provide additional receptacle(s) on roof so all equipment is within 25' of connection.
NEC Article 250.50 Grounding electrode system
Corrective Action Required
02/25/2022

2017 NEC Article 250.50 Grounding Electrode System. All Grounding electrodes as described in 250.52(A)(1) through (A)(7) that are present at each building or structure served shall be bonded together to form the grounding electrodes system. Where none of these grounding electrodes exist, one or more of the grounding electrodes specified in 250.52(A)(4) through (A)(8) shall be installed and used. (see code section for exception) Action required: Provide complete diagram for grounding scenario at service disconnect.
Licensed Contractors Rejected 03/03/2022 02/25/2022
Joe Frogge
LC - MEP Subs
Corrective Action Required
02/25/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
LC - General Contractor
Corrective Action Required
02/25/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact which is where inspection reports will be sent.
Fire Plan Review Approved with Conditions 03/03/2022 02/22/2022
Ben Hicks
Installation acceptance testing
Corrective Action Required
02/22/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational purposes) (Call 816-969-1300 to schedule hood trip test)
Emergency power for illumination
Corrective Action Required
02/22/2022

2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits. (Verified at inspection) (Provide External illumination at all exits)
Fees
Paid Fees Amount Paid Owing Date Paid
8331507-Sewer Connection Fee $300.00 $300.00 Paid 05/17/2022
Valuation Fee for New Commercial $2,400.00 $2,400.00 Paid 05/17/2022
Commercial Excise Tax Fee $33,705.00 $33,705.00 Paid 05/17/2022
Site Grading Fee $1,658.40 $1,658.40 Paid 05/17/2022
Paved Surface Inspection Fee $5,709.03 $5,709.03 Paid 05/17/2022
Water Insp Fee $335.85 $335.85 Paid 05/17/2022
Sanitary Sewer Insp Fees $271.74 $271.74 Paid 05/17/2022
Storm Sewer Inspection Fee $1,065.54 $1,065.54 Paid 05/17/2022
Water Meter Fee $3,674.69 $3,674.69 Paid 05/17/2022
Water Tap Fee $18,280.00 $18,280.00 Paid 05/17/2022
Not Ready Inspection Fee $75.00 $75.00 Paid 03/02/2023
Not Ready Inspection Fee $75.00 $75.00 Paid 03/02/2023
Not Ready Inspection Fee $75.00 $75.00 Paid 03/02/2023
After Hours Inspections (Public Works)(Per Hour) $125.00 $125.00 Paid 03/02/2023
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Residential Partial 08/03/2022
Misc
Informational
08/03/2022
08/03/22 Wednesday JMJ Fencing and silt was installed last week and passed inspection.
Erosion Control Inspection Residential Partial 08/09/2022
Misc
Informational
08/09/2022
08/03/22 Wednesday JMJ Fencing and silt was installed last week and passed inspection. 08/09/22 Tuesday JMJ Erosion control measures are still in place and contractor started building pad.
Erosion Control Inspection Residential Failed 08/19/2022
Misc
Corrective Action Required
08/19/2022
08/19/22 Friday JMJ 40% of the 6’ metal fencing with green screen wrapping has collapsed/ fallen down on project site. The fencing needs to be re-erected and secured to prevent it from falling down.
Erosion Control Inspection Residential Partial 08/25/2022
Misc
Informational
08/25/2022
08/25/22 Thursday JMJ Collapse perimeter metal fencing was raised on 08/24/22 Wednesday.
Commercial Curb Inspection Partial 08/31/2022
Misc
Informational
08/31/2022

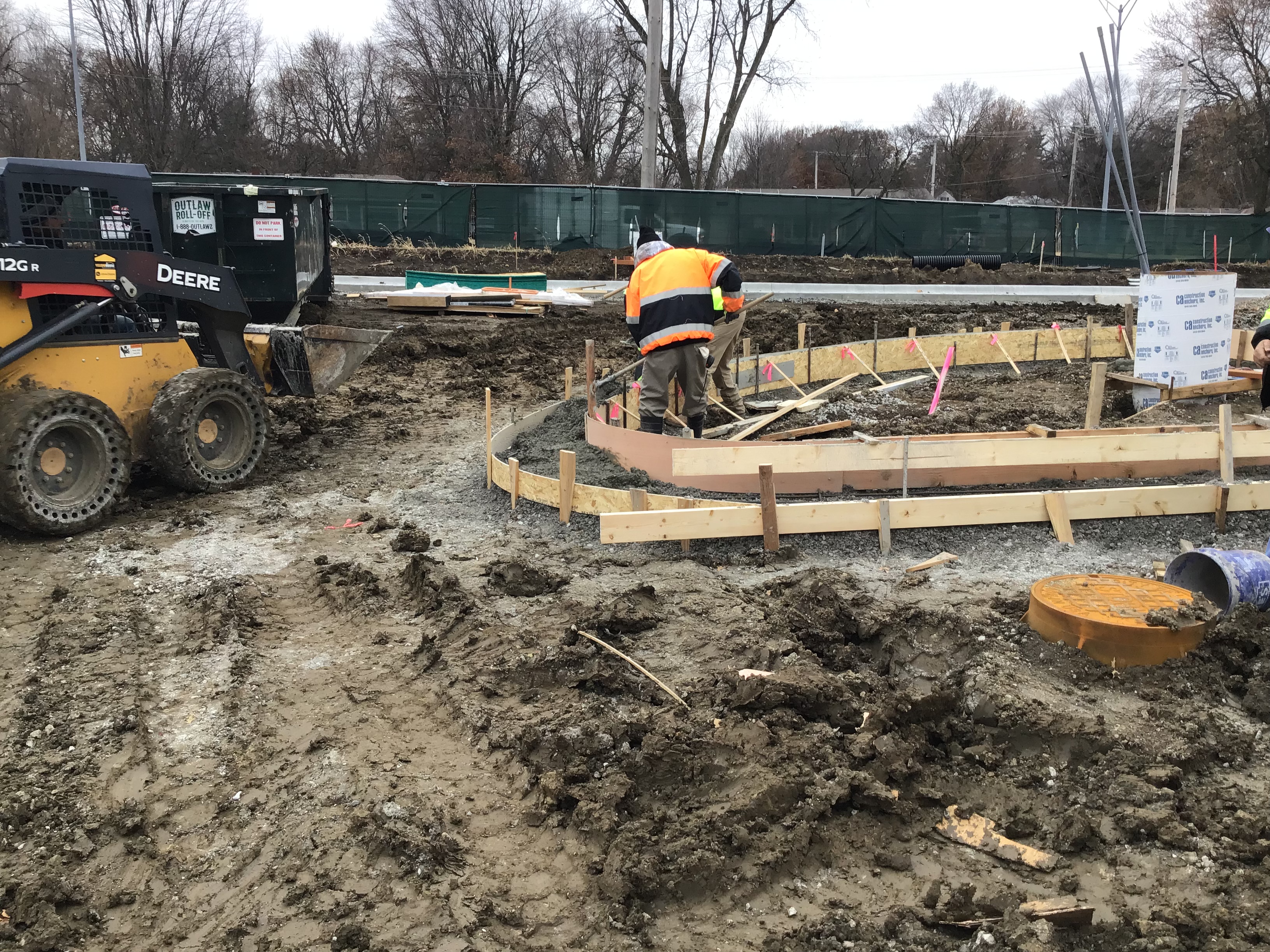

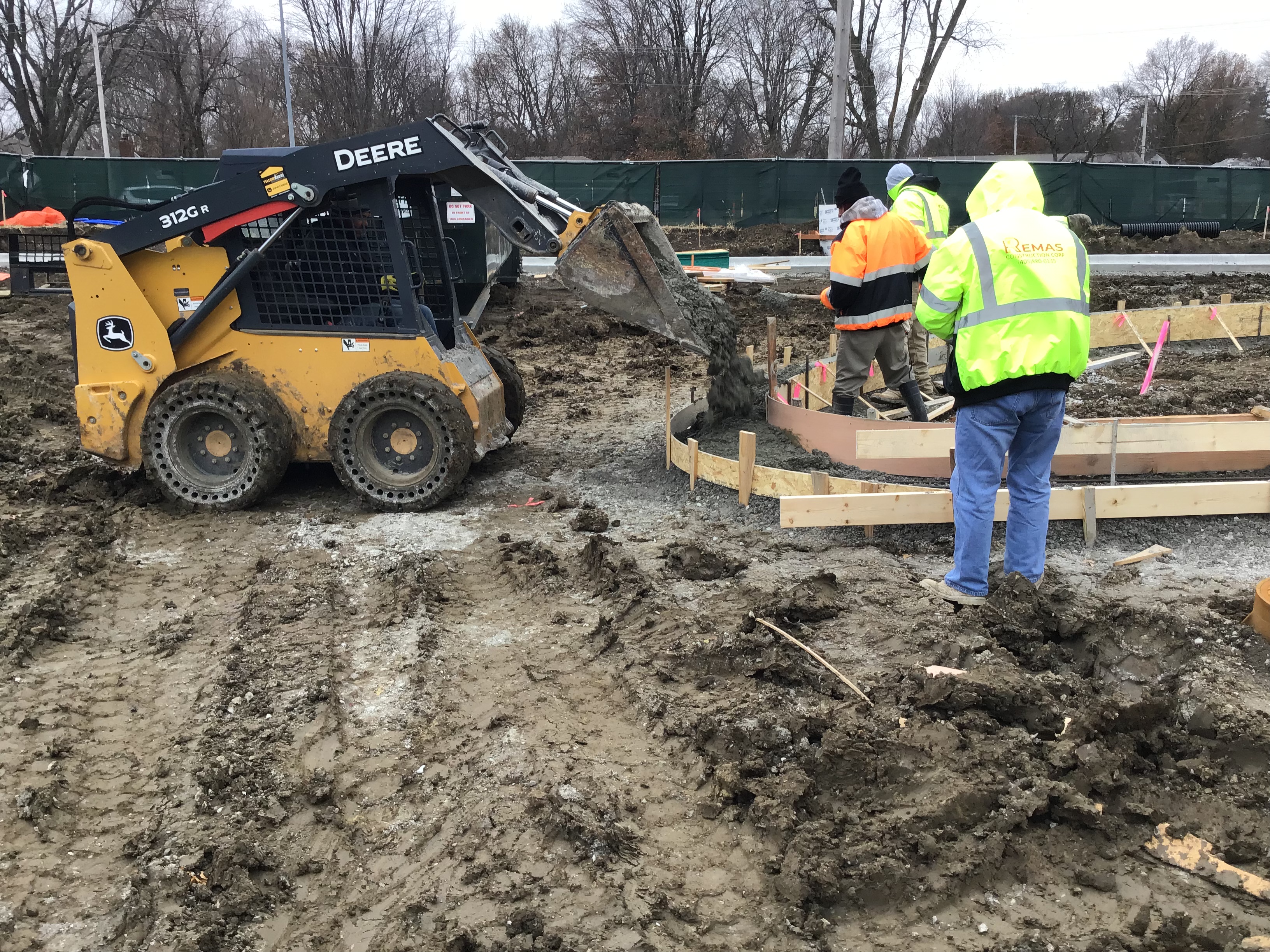

O8/31/22 Wednesday JMJ ( Precision Construction ) Curbs were installed at 1:00PM.

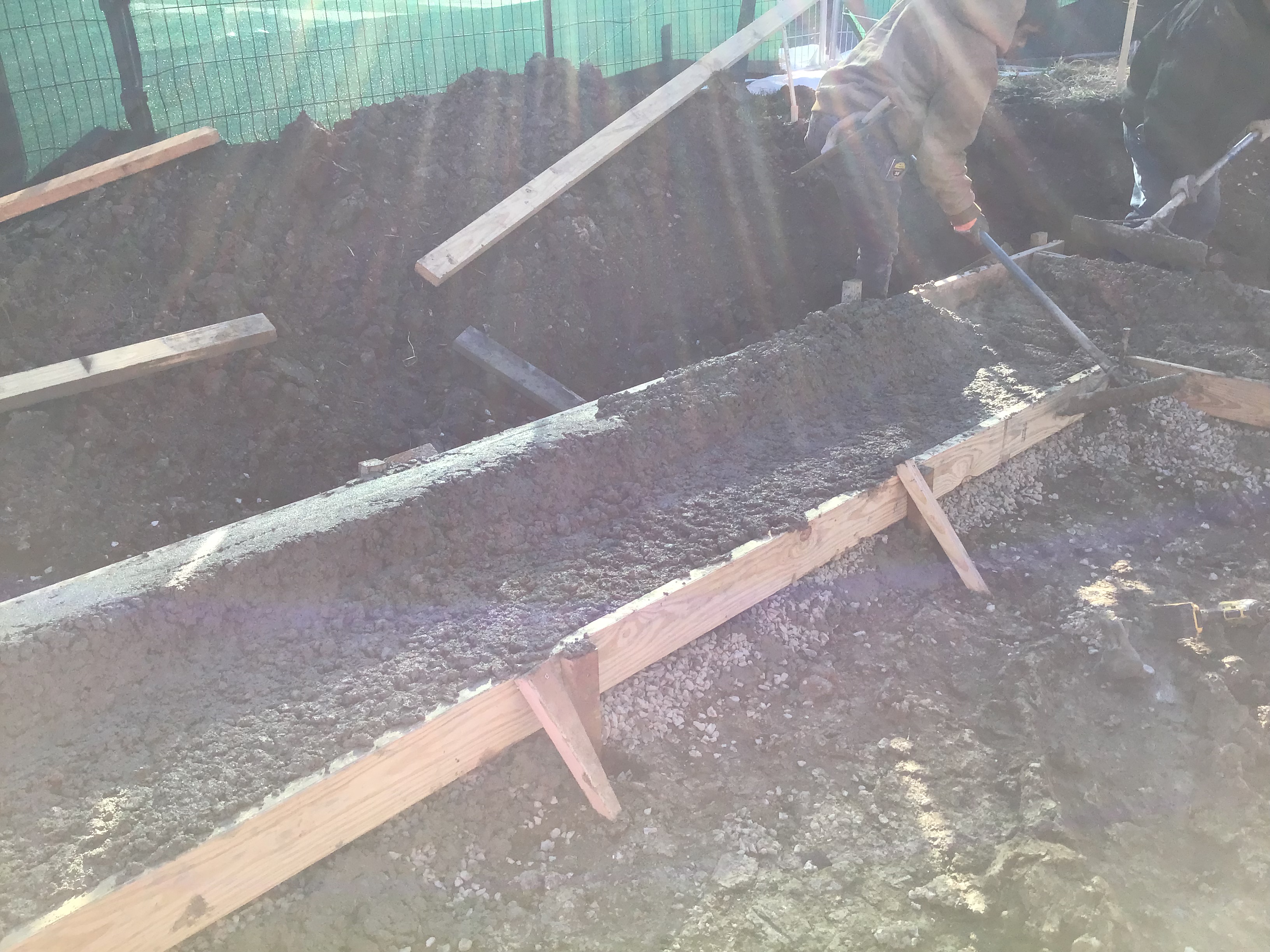

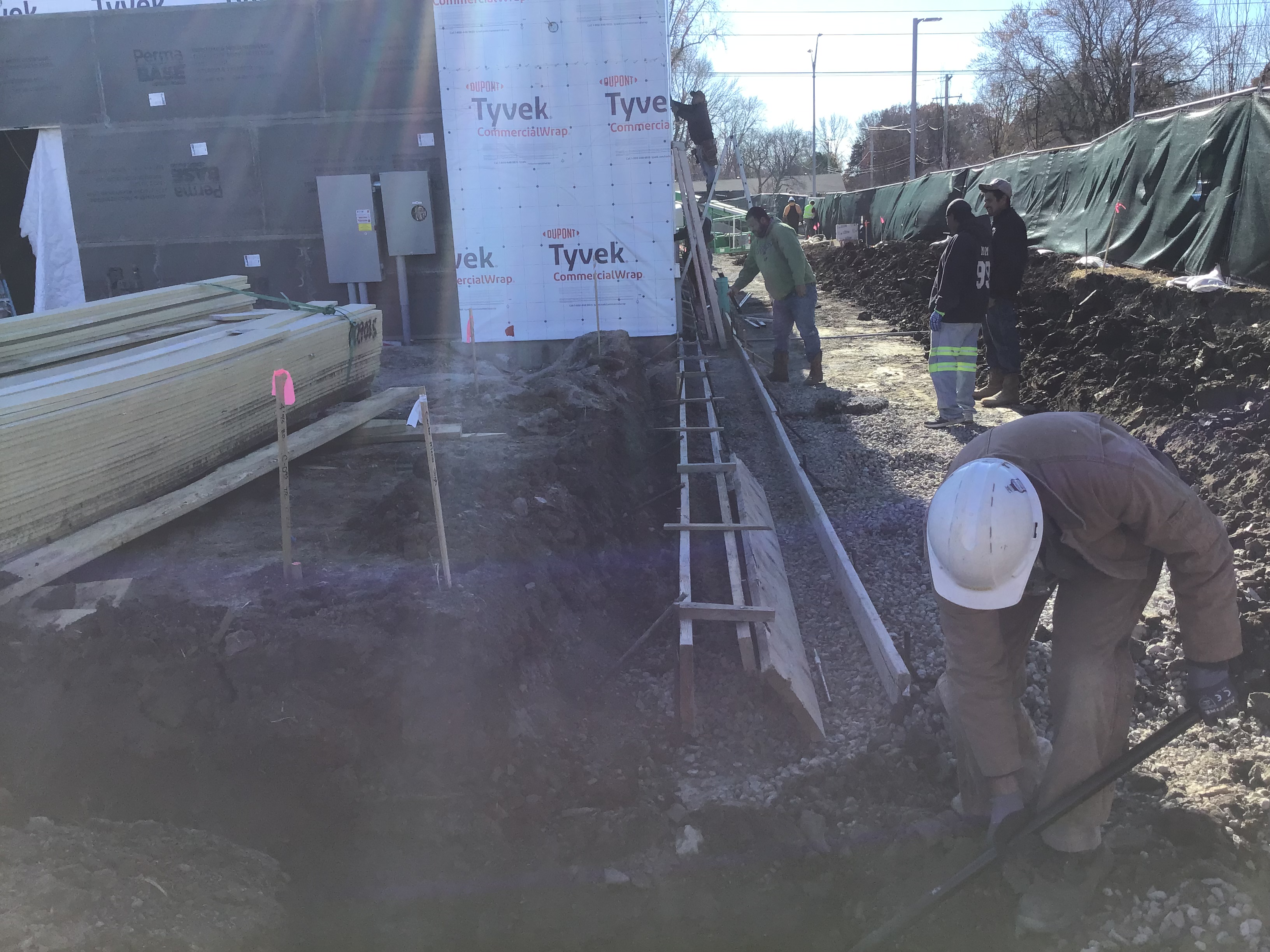

Footing Inspection - Commercial Passed 9/2/2022 9/2/2022 09/02/2022
Misc
Informational
09/02/2022

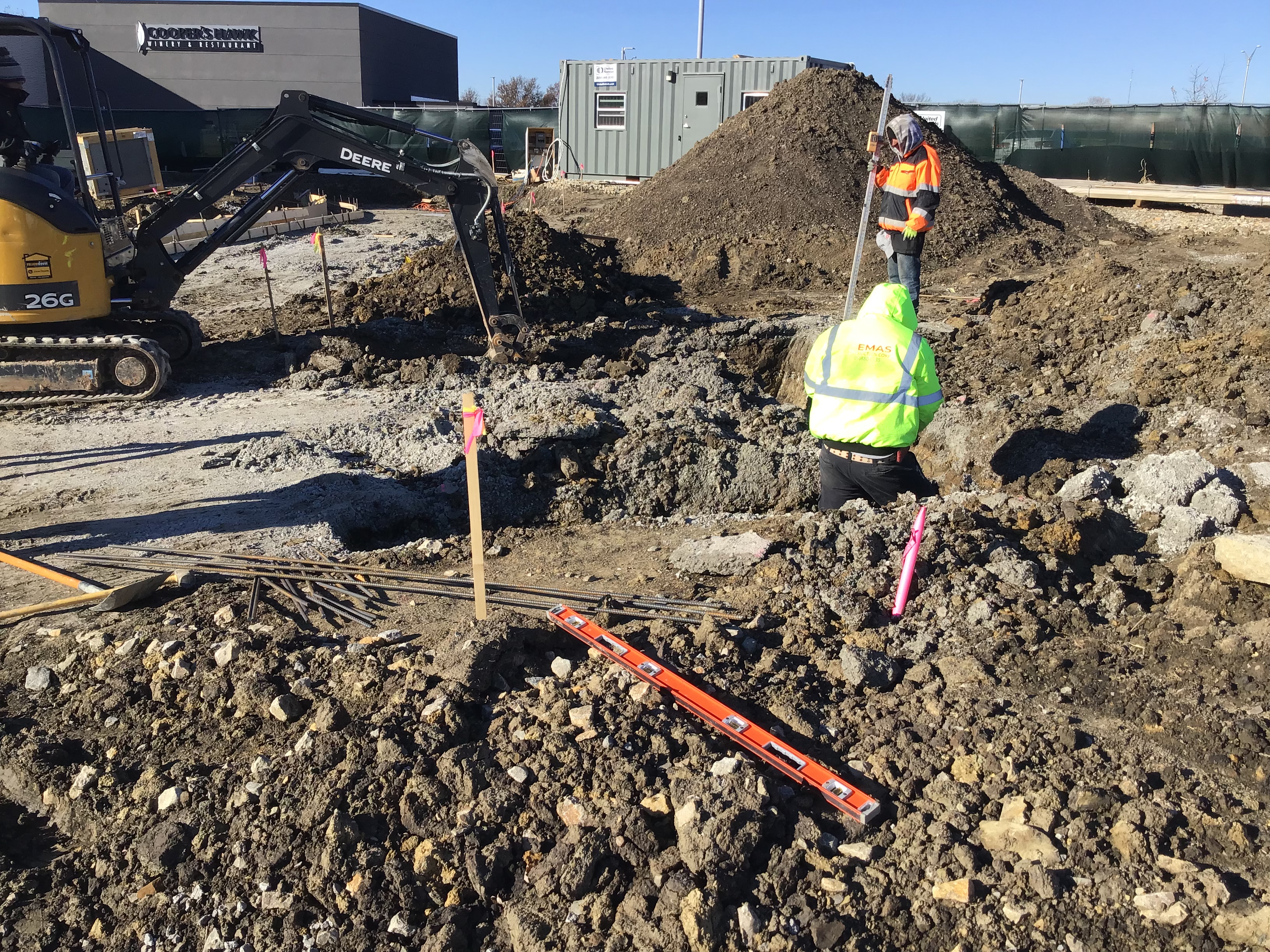

UFER LOCATED NORTH WEST CORNER

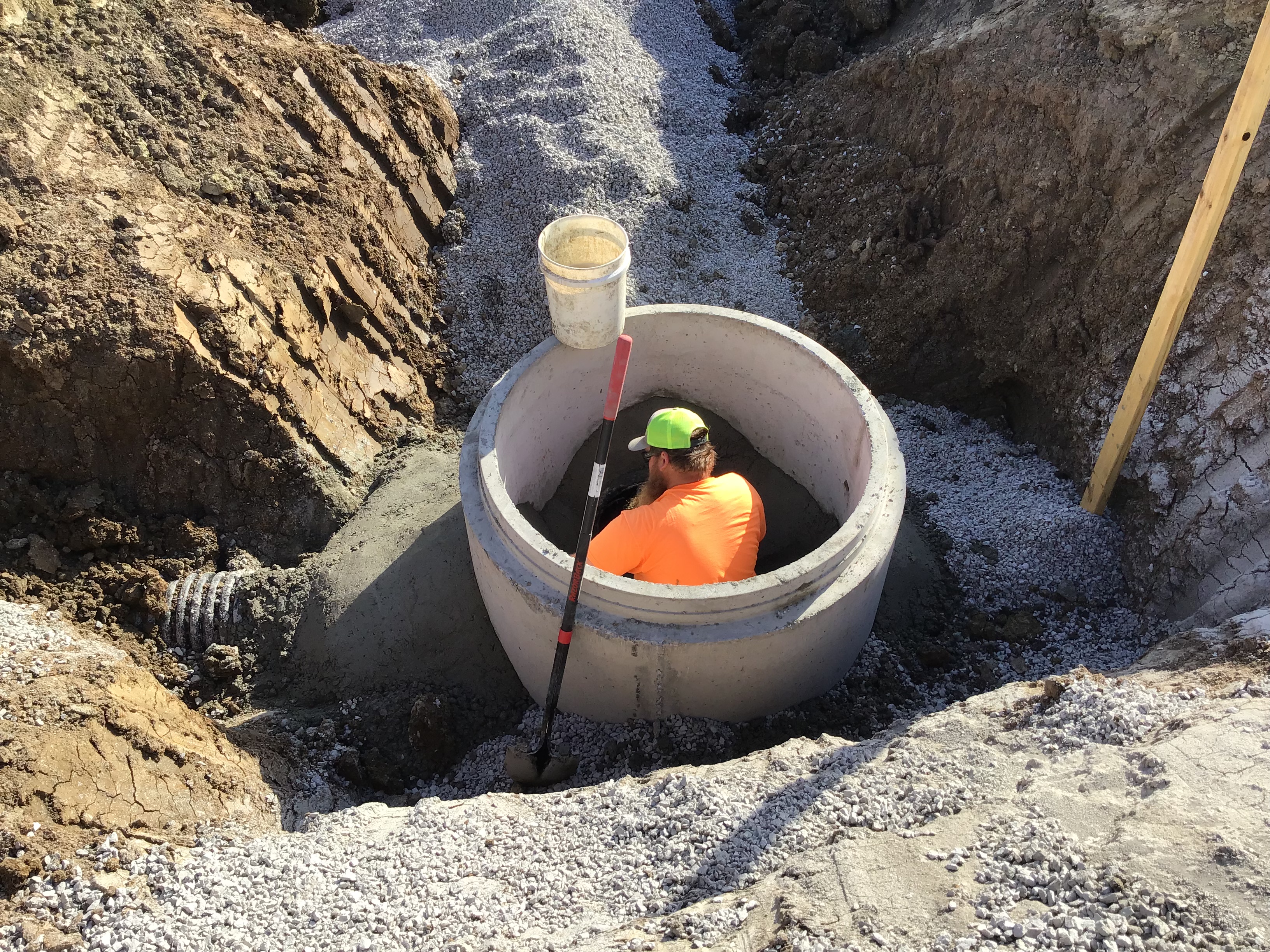

Water Service Inspection Partial 09/07/2022
Misc
Informational
09/07/2022

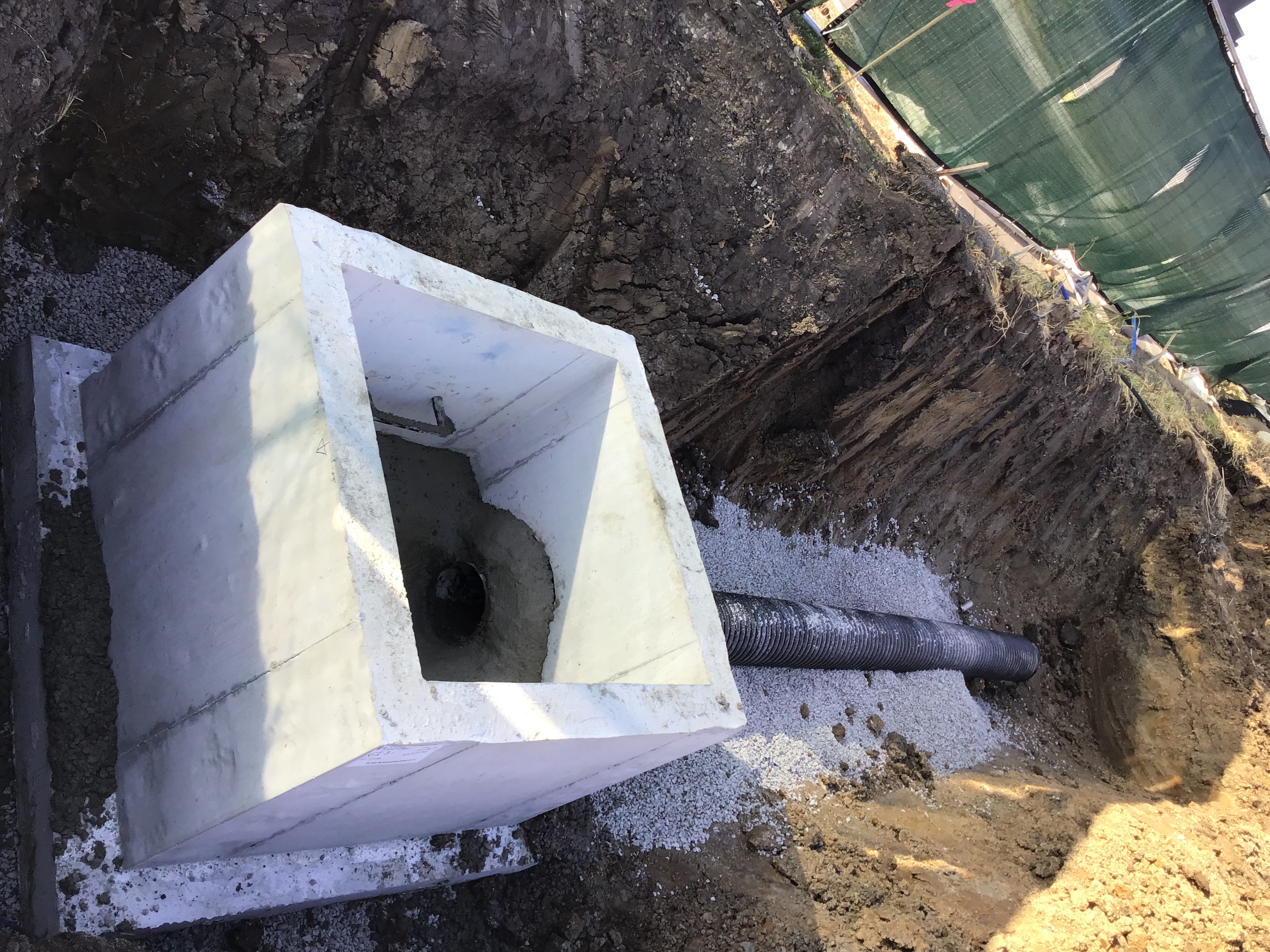

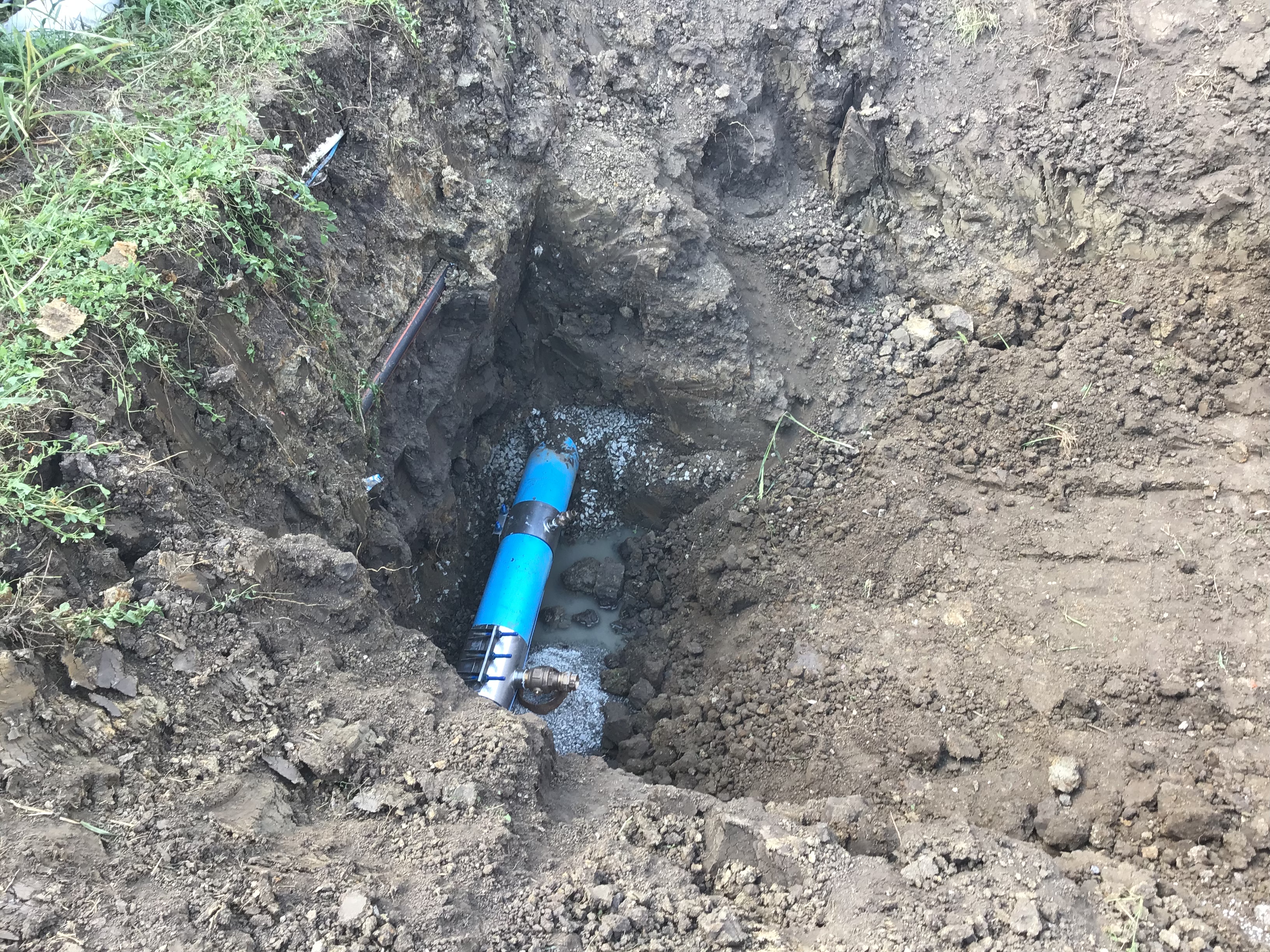

09/07/22 Wednesday ( Complete Construction ) Water Services tap 12” main for domestic & irrigation taps. Contractor is working to install meters for taps.

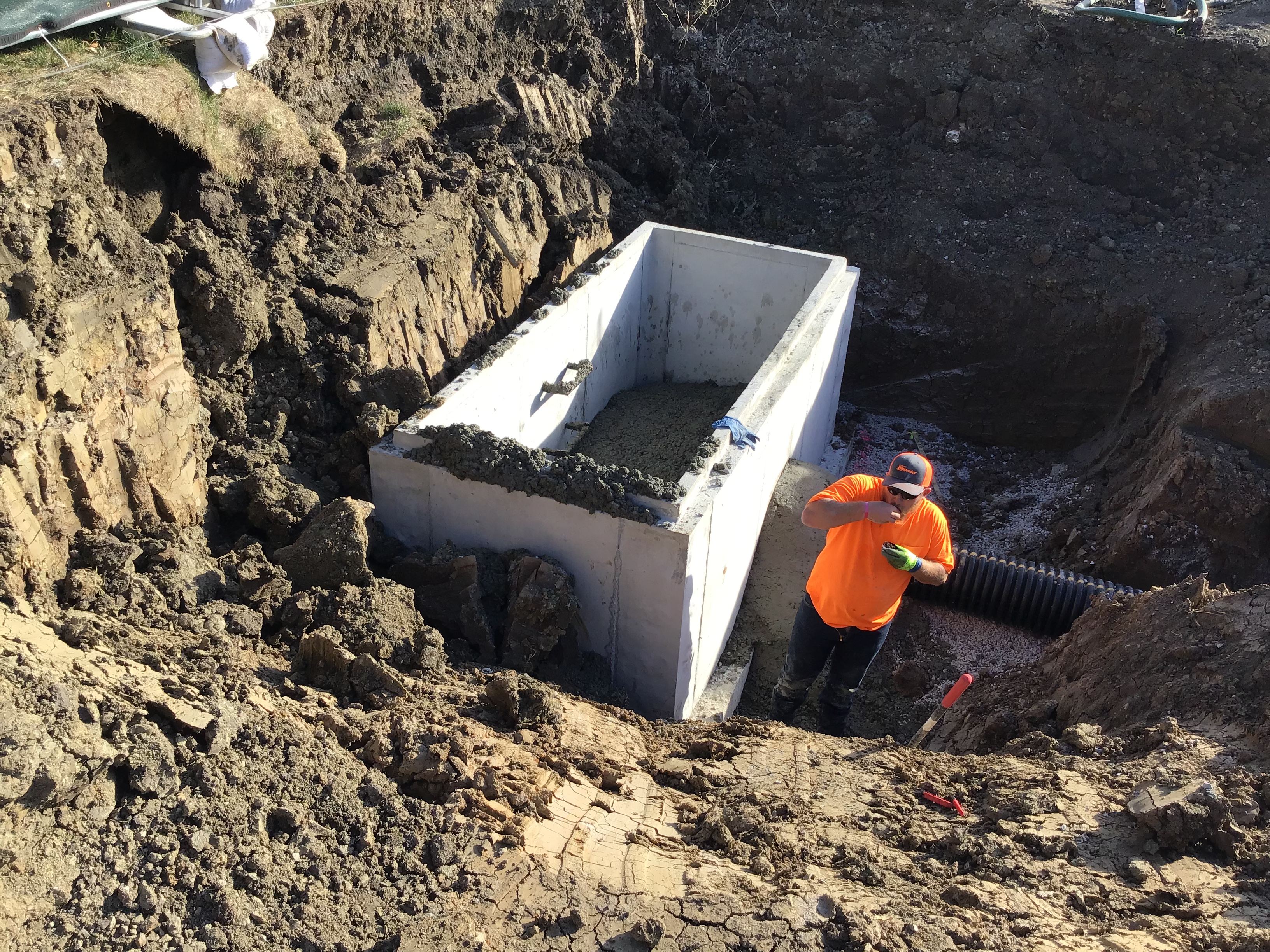

Sanitary Sewer Construction Inspection Partial 09/07/2022
Misc
Informational
09/07/2022
09/07/22 Wednesday JMJ ( Complete Construction ) Contractor connected to the existing 4” sanitary sewer main approximately 60’ with 1 clean-out. Contractor also ran tracer wire for locate of sanitary sewer line.
Water Service Inspection Partial 09/08/2022
Misc
Informational
09/08/2022
09/08/22 Thursday JMJ ( Complete Construction ) Contractor worked to set water & irrigation meters.
Sanitary Sewer Construction Inspection Partial 09/08/2022
Misc
Informational
09/07/2022
09/07/22 Wednesday JMJ ( Complete Construction ) Contractor connected to the existing 4” sanitary sewer main approximately 60’ with 1 clean-out. Contractor also ran tracer wire for locate of sanitary sewer line. 09/08/22 Thursday JMJ (Complete Construction ) Contractor continued installation of 4” sanitary main towards grease trap approximately 30’
Water Service Inspection Partial 09/09/2022
Misc
Informational
09/08/2022
09/08/22 Thursday JMJ ( Complete Construction ) Contractor worked to set water & irrigation meters. 09/09/22 Friday JMJ ( Complete Construction ) Continued to install Meter pits and piping.
Sanitary Sewer Construction Inspection Partial 09/09/2022
Misc
Informational
09/08/2022
09/07/22 Wednesday JMJ ( Complete Construction ) Contractor connected to the existing 4” sanitary sewer main approximately 60’ with 1 clean-out. Contractor also ran tracer wire for locate of sanitary sewer line. 09/08/22 Thursday JMJ (Complete Construction ) Contractor continued installation of 4” sanitary main towards grease trap approximately 30’. 09/09/22 Friday JMJ ( Complete Construction ) Sanitary pipelines and clean outs were installed up to Grease Pit.
Underground Electrical Inspection - Commercial Partial 9/22/2022 9/22/2022 09/22/2022
Misc
Informational
09/22/2022
PARTIAL PASS ELECTRICAL CONDUIT WEST TRANSFORMER ABOUT 60' EAST TO GATE

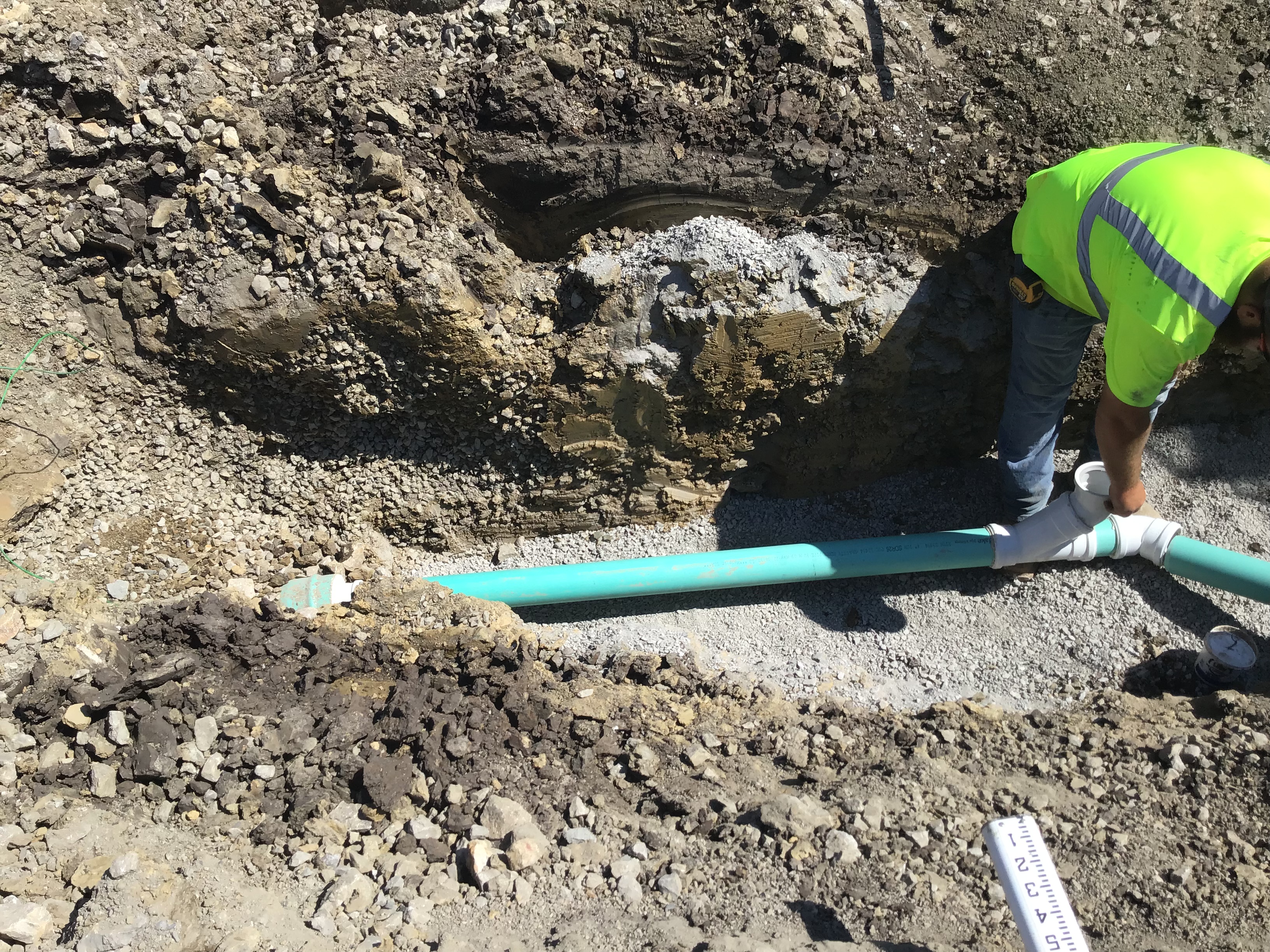

Underslab Plumbing Inspection - Commercial Passed 9/22/2022 9/22/2022 09/22/2022
Misc
Informational
09/22/2022
SANITARY & GREASE LINES
Underground Electrical Inspection - Commercial Partial 9/28/2022 9/28/2022 09/28/2022
Misc
Informational
09/22/2022
PARTIAL PASS ELECTRICAL CONDUIT WEST TRANSFORMER ABOUT 60' EAST TO GATE - IT CONDUIT FRONT OF BUILDING TO SIDEWALK OK TO COVER -
Underslab Electrical Inspection - Commercial Passed 9/28/2022 09/28/2022
Underground Plumbing Inspection - Commercial Passed 10/4/2022 10/04/2022
Misc
Informational
10/04/2022
GREASE TRAP PER PLAN
Footing Inspection - Commercial Failed 10/5/2022 10/5/2022 10/05/2022
Miscellaneous Correction
Corrective Action Required
10/05/2022
CHAIR UP MATS & SPACE OFF EDGES 3" NO GROUND CONTACT PROVIDE # 3 TIES ON COLUMNS

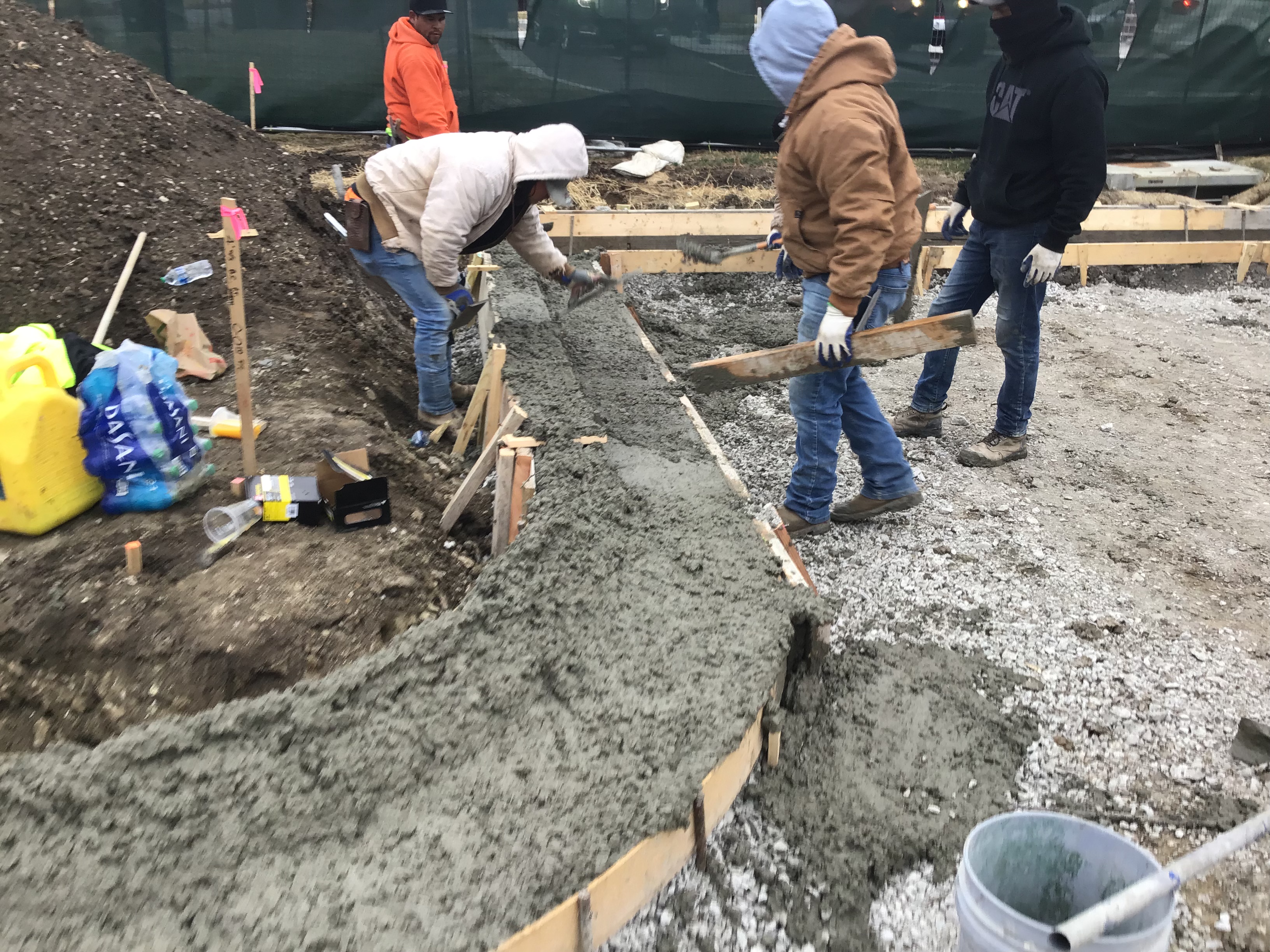

Footing Inspection - Commercial Partial 10/5/2022 10/05/2022
Miscellaneous Correction
Corrective Action Required
10/05/2022
-(4) FOOTINGS FOR CANOPY SW CORNER OF BLDG (3) GRADE BEAMS IN BLDG SLAB OK TO POUR - PROVIDE # 3 TIES @ 2" OC ON TOP OF COLUMNS PER PLAN
Site Visit Partial 10/06/2022
Misc
Informational
10/06/2022

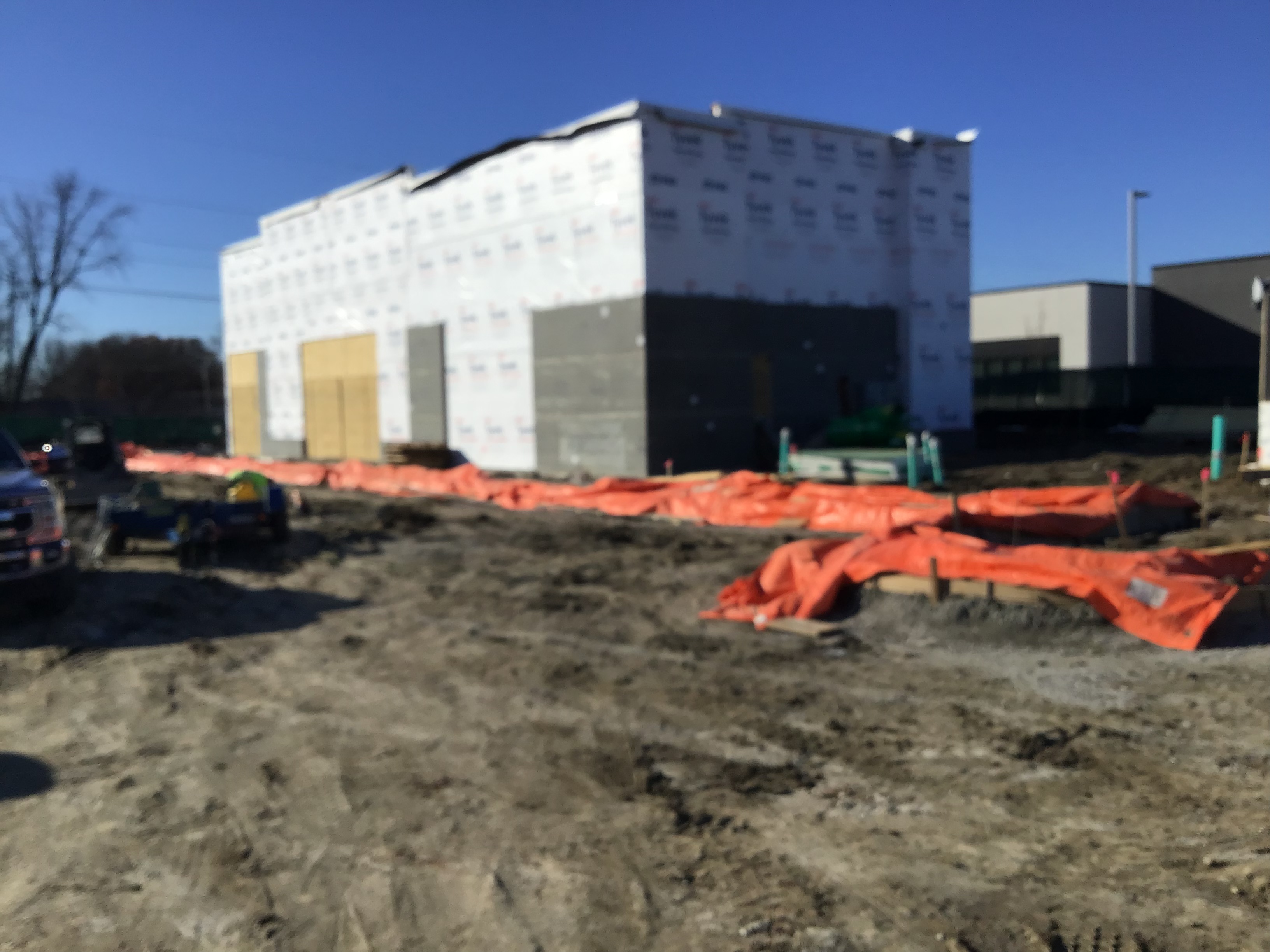

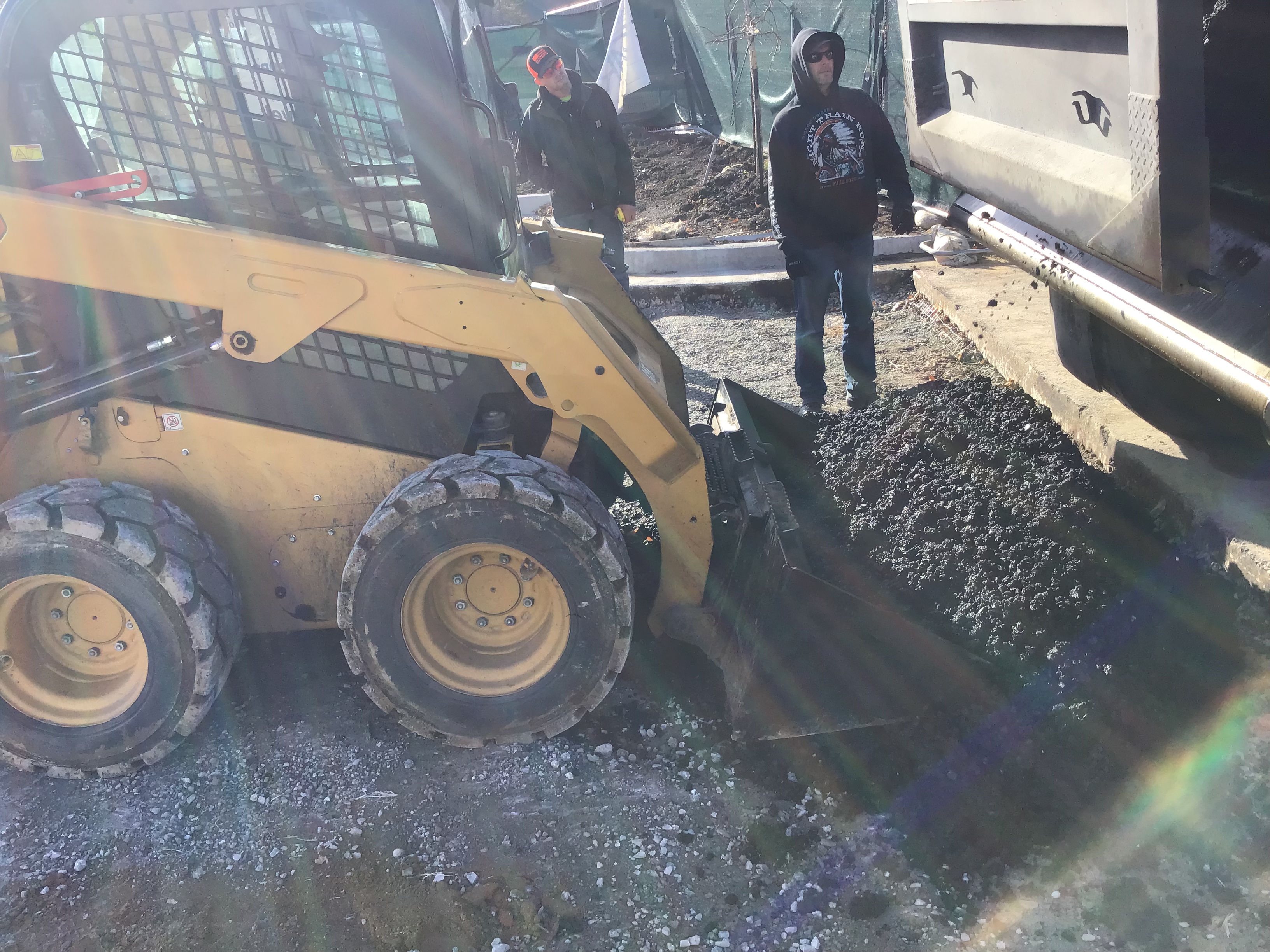

10/06/22 Thursday JMJ ( Parkway Construction ) Grading and hauling away of spoils. Third party was onsite to collect concrete cylinders Alpha-Omega Geotech for building pads.
Erosion Control Inspection Residential Partial 10/25/2022
Misc
Informational
10/25/2022
10/25/22 Tuesday JMJ Erosion still functioning at site.
Storm Sewer Construction Inspection Partial 10/28/2022
Misc
Informational
10/28/2022
10/28/22 Friday JMJ ( Parkway Inc/ Complete Excavation ) Contractor began installing the Storm structures A-1, A-2 Boxes off the existing 36” HDPE corrugated storm pipe. Also the 2 round storm structures that will be attached with a 12” HDPE storm structure as per plan.
Storm Sewer Construction Inspection Partial 10/31/2022
Misc
Informational
10/28/2022
10/28/22 Friday JMJ ( Parkway Inc/ Complete Excavation ) Contractor began installing the Storm structures A-1, A-2 Boxes off the existing 36” HDPE corrugated storm pipe. Also the 2 round storm structures that will be attached with a 12” HDPE storm structure as per plan. 10/31/22 Monday JMJ ( Complete Excavation ) Contractor installed today approximately 55’ of 18” HDPE corrugated storm pipe from A-1 Inlet Approximately 15’ of 12” of HDPE, 90 deg bend, cutting a serta 36”X18” tee into exist storm sewer pipe 10/28/22 Friday. Contractor will work on the installation of A-2 Inlet and storm pipe to connnect to existing 36” storm sewer pipe.
Storm Sewer Construction Inspection Partial 10/31/2022
Misc
Informational
10/31/2022
10/28/22 Friday JMJ ( Parkway Inc/ Complete Excavation ) Contractor began installing the Storm structures A-1, A-2 Boxes off the existing 36” HDPE corrugated storm pipe. Also the 2 round storm structures that will be attached with a 12” HDPE storm structure as per plan. 10/31/22 Monday JMJ ( Complete Excavation ) Contractor installed today approximately 55’ of 18” HDPE corrugated storm pipe from A-2 Inlet Approximately 15’ of 12” of HDPE, 90 deg bend, cutting a serta 36”X18” tee into exist storm sewer pipe & junction box base structure. 10/28/22 Friday. Contractor will work on the installation of A-1Inlet and storm pipe to connnect to existing 36” storm sewer pipe. Storm box A-1 was installed along with approximately 20’ of 18” HDPE corrugated storm pipe out of Inlet structure. Inverts and collars were poured. Also

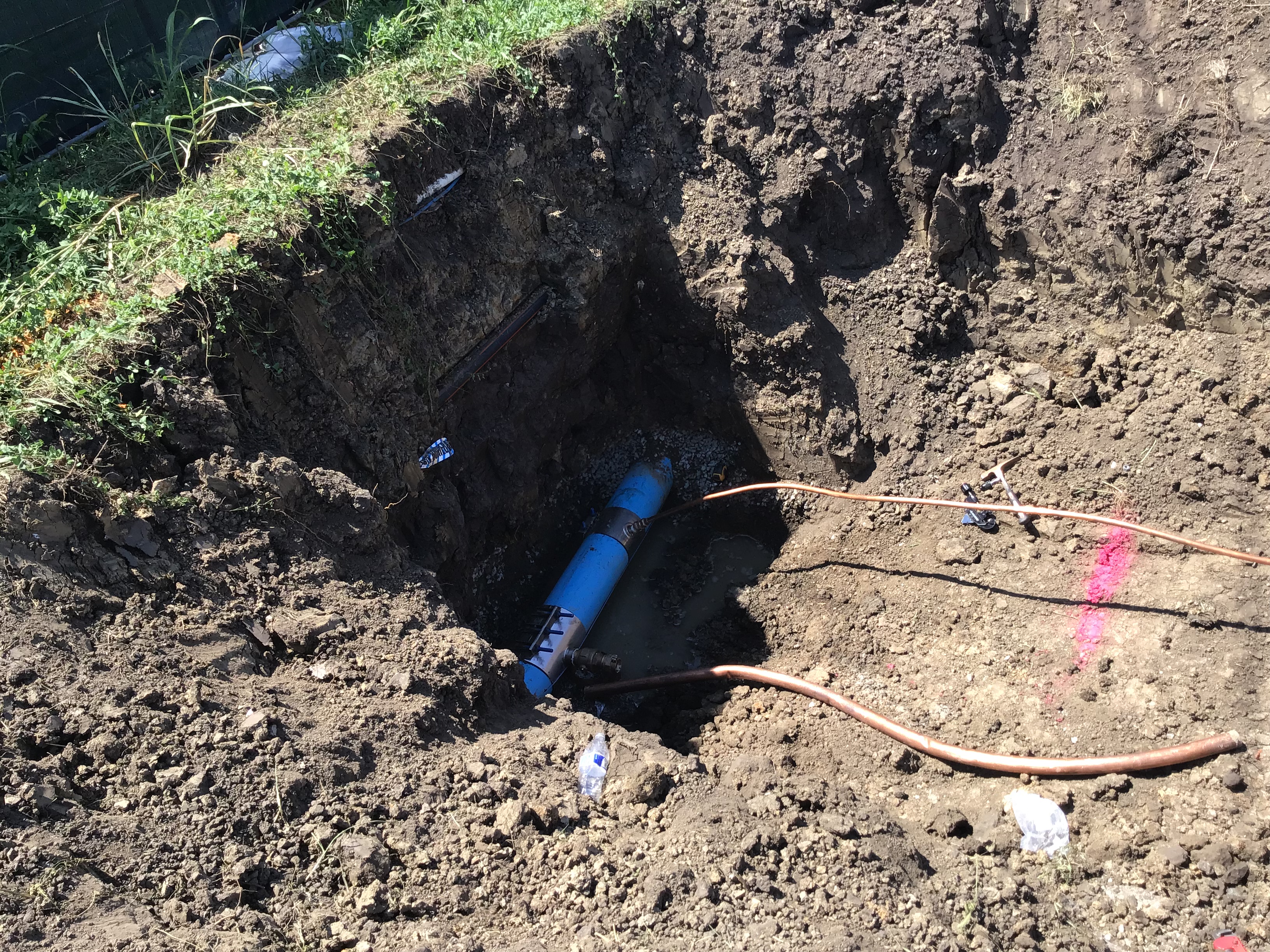

Storm Sewer Construction Inspection Partial 11/01/2022
Misc
Informational
10/31/2022
10/28/22 Friday JMJ ( Parkway Inc/ Complete Excavation ) Contractor began installing the Storm structures A-1, A-2 Boxes off the existing 36” HDPE corrugated storm pipe. Also the 2 round storm structures that will be attached with a 12” HDPE storm structure as per plan. 10/31/22 Monday JMJ ( Complete Excavation ) Contractor installed today approximately 55’ of 18” HDPE corrugated storm pipe from A-2 Inlet Approximately 15’ of 12” of HDPE, 90 deg bend, cutting a serta 36”X18” tee into exist storm sewer pipe & junction box base structure. 10/28/22 Friday. Contractor will work on the installation of A-1Inlet and storm pipe to connnect to existing 36” storm sewer pipe. Storm box A-1 was installed along with approximately 20’ of 18” HDPE corrugated storm pipe out of Inlet structure. Inverts and collars were poured. Also 11/01/22 Tuesday JMJ ( Complete Excavation ) Contractor began to cut into 36” HDPE storm pipe for tie-in to A-1 Inlet. Serta 36”X18” tee from existing to a 90 deg bend.
Storm Sewer Construction Inspection Partial 11/02/2022
Misc
Informational
11/01/2022
10/28/22 Friday JMJ ( Parkway Inc/ Complete Excavation ) Contractor began installing the Storm structures A-1, A-2 Boxes off the existing 36” HDPE corrugated storm pipe. Also the 2 round storm structures that will be attached with a 12” HDPE storm structure as per plan. 10/31/22 Monday JMJ ( Complete Excavation ) Contractor installed today approximately 55’ of 18” HDPE corrugated storm pipe from A-2 Inlet Approximately 15’ of 12” of HDPE, 90 deg bend, cutting a serta 36”X18” tee into exist storm sewer pipe & junction box base structure. 10/28/22 Friday. Contractor will work on the installation of A-1Inlet and storm pipe to connnect to existing 36” storm sewer pipe. Storm box A-1 was installed along with approximately 20’ of 18” HDPE corrugated storm pipe out of Inlet structure. Inverts and collars were poured. Also 11/01/22 Tuesday JMJ ( Complete Excavation ) Contractor began to cut into 36” HDPE storm pipe for tie-in to A-1 Inlet. Serta 36”X18” tee from existing to a 90 deg bend. 11/02/22 Tuesday JMJ ( Complete Excavation ) Contractor installed approximately 40’ of SDR 35 storm sewer pipe for roof drain attach to the junction box. Lids were placed on junction box, A-1, & A-2 IN structure and excavation was backfilled. Contractor also removed spoils from site location.

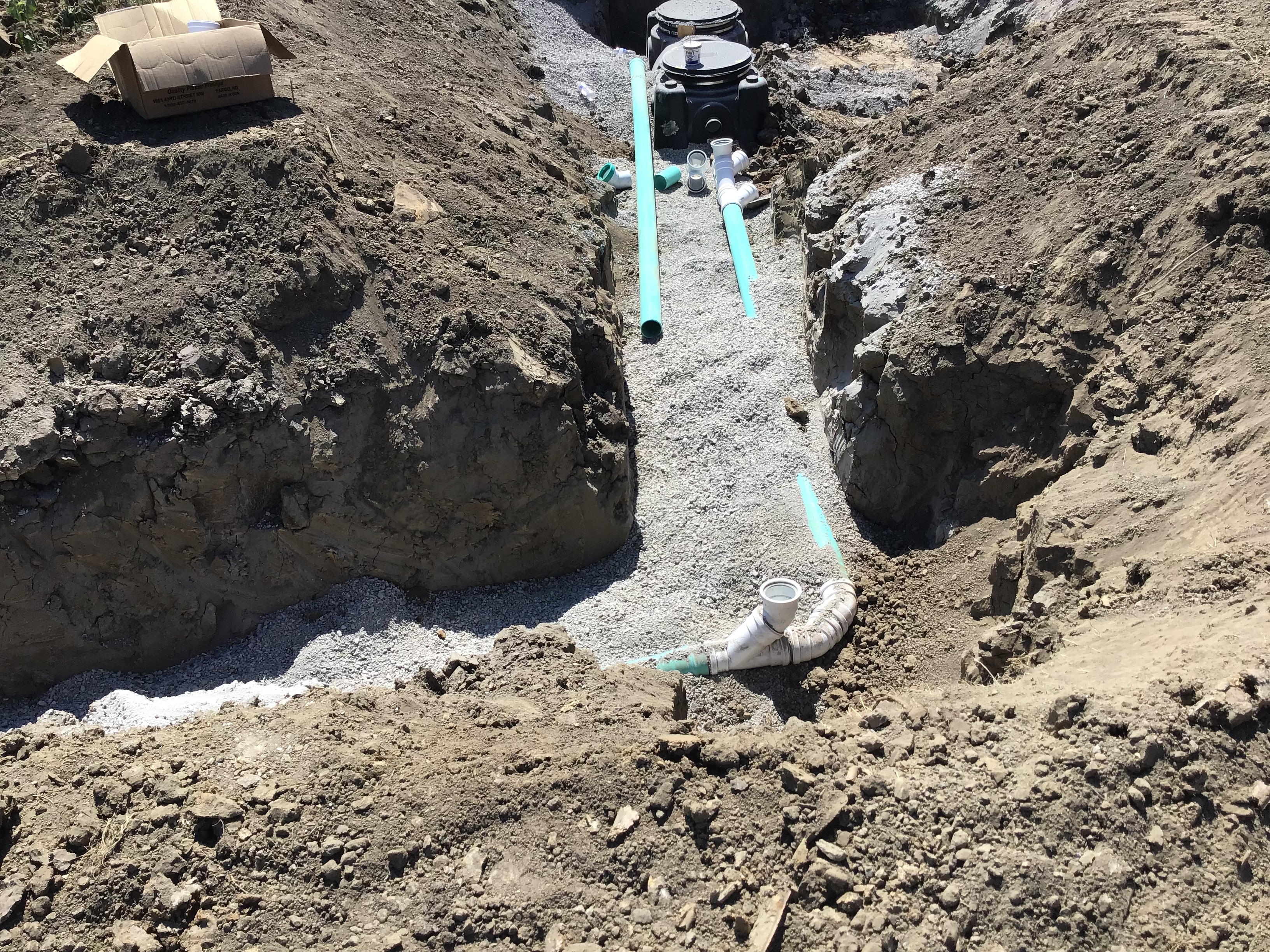

Roof Drain Partial 11/03/2022
Misc
Informational
11/03/2022
11/03/22 Thursday JMJ ( Complete Construction ) Contractor installed approximately 160’ of SDR storm pipe, and fittings as per project plans. Contractor backfilled excavation.
Roof Drain Partial 11/03/2022
Misc
Informational
11/03/2022
11/03/22 Thursday JMJ ( Complete Construction ) Contractor installed approximately 160’ of SDR storm pipe, and fittings as per project plans. Contractor backfilled excavation.
Erosion Control Inspection Residential Partial 11/07/2022
Misc
Corrective Action Required
11/07/2022
11/07/22 Monday Erosion control appears to be working. I will talk with contractor to ensure street are cleaned from tracking mud and spoils from site location.

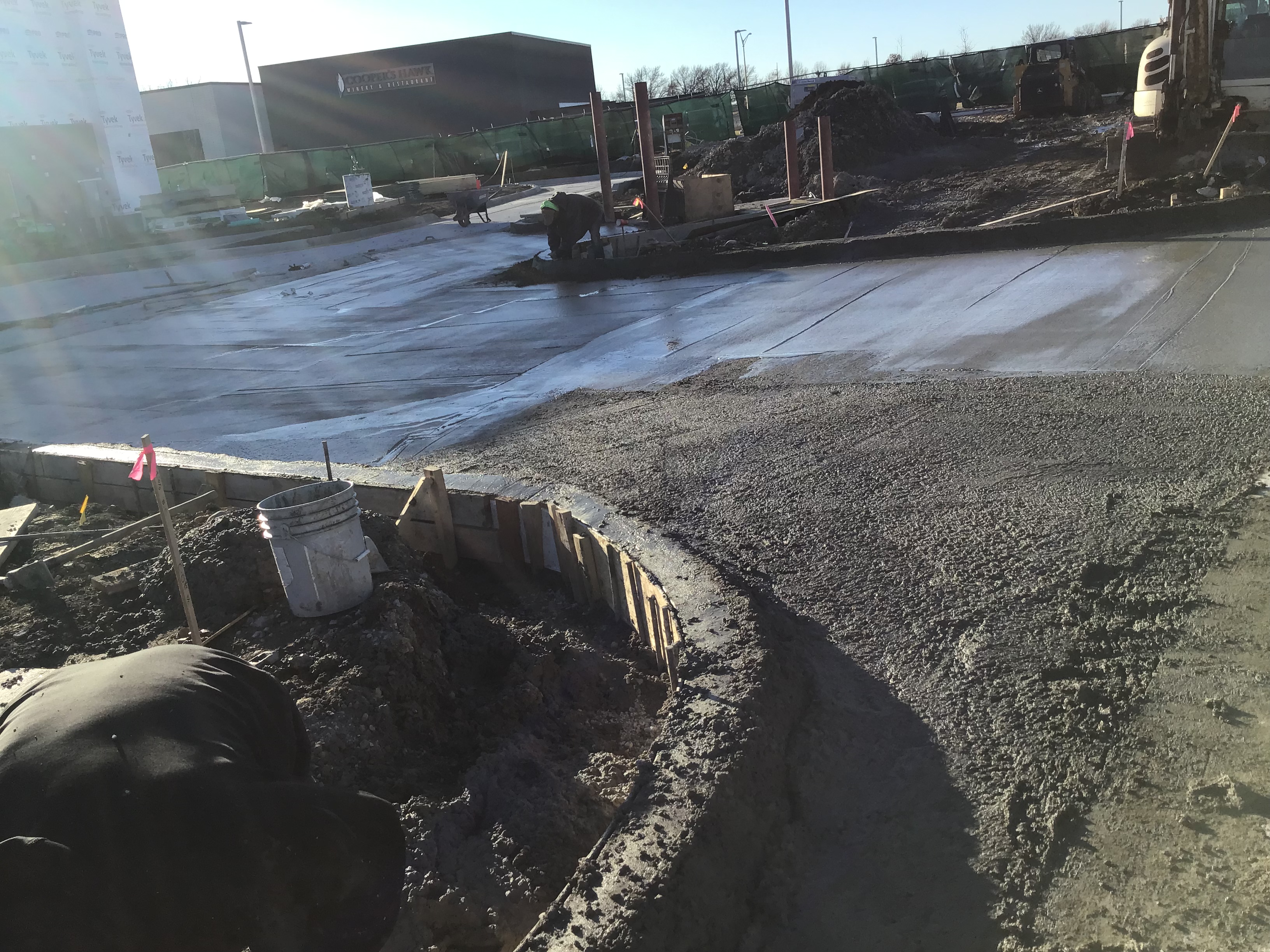

Pavement-Curb Construction Partial 11/16/2022
Misc
Informational
11/16/2022
11/16/22 Wednesday JMJ ( Remas Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs.
In-wall Inspection Failed 11/17/2022 11/17/2022 11/17/2022
Miscellaneous Correction
Corrective Action Required
11/17/2022
PROVIDE ANCHOR BOLTS NUTS & WASHERS AT HOLDDOWNS IN COOLER AREA COMPLETE MEPs FOR IN WALL INSPECTION
Pavement-Curb Construction Partial 11/21/2022
Misc
Informational
11/16/2022
11/16/22 Wednesday JMJ ( Remas Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM.
Underground Electrical Inspection - Commercial Partial 11/22/2022 11/22/2022
Misc
Informational
09/28/2022
PARTIAL PASS ELECTRICAL CONDUIT WEST TRANSFORMER ABOUT 60' EAST TO GATE - IT CONDUIT FRONT OF BUILDING TO SIDEWALK OK TO COVER - - 11/22/22 CONDUIT FOR (7) LIGHT POLE BASES OK TO BACKFILL -
Piers/Caissons Inspection - Commercial Failed 11/22/2022 (8:00) 11/22/2022 11/22/2022
Miscellaneous Correction
Corrective Action Required
11/22/2022
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101
Commercial Curb Inspection Partial 11/29/2022
Misc
Informational
08/31/2022
08/31/22 Wednesday JMJ ( Precision Construction ) Curbs were installed at 1:00PM. 11/29/22 Tuesday JMJ Contractor continued curbs forms and materials around building and for project. Alpha & Omega testing lab will do the third party inspections for parking lot. Contractor will call if concrete schedule pour is moved up from tomorrow morning.
Pavement-Curb Construction Partial 11/29/2022
Misc
Informational
11/21/2022
11/16/22 Wednesday JMJ ( Remas Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs.
Pavement-Curb Construction Partial 11/30/2022
Misc
Informational
11/29/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Eastside. Blankets where used to cover curbs due to the overnight drop in temperatures.
Piers/Caissons Inspection - Commercial Failed 11/30/2022 11/30/2022
Miscellaneous Correction
Corrective Action Required
11/22/2022
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 11/30/22 PUMP WATER FROM PIERS AND COMPLETE REBAR FROM PREVIOUS INSPECTION
Footing Inspection - Commercial Partial 11/30/2022
Miscellaneous Correction
Corrective Action Required
10/05/2022
-(4) FOOTINGS FOR CANOPY SW CORNER OF BLDG (3) GRADE BEAMS IN BLDG SLAB OK TO POUR - -FOOTING AT DUMPSTER ENCLOSURE OK PROVIDE # 3 TIES @ 2" OC ON TOP OF COLUMNS PER PLAN
Commercial Curb Inspection Partial 11/30/2022
Misc
Informational
11/29/2022
08/31/22 Wednesday JMJ ( Precision Construction ) Curbs were installed at 1:00PM. 11/29/22 Tuesday JMJ ( Remuas Concrete ) Contractor continued curbs forms and materials around building and for project. Alpha & Omega testing lab will do the third party inspections for parking lot. Contractor will call if concrete schedule pour is moved up from tomorrow morning. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor continued pour curbs on the Westside building. The concrete truck gut stuck and had to be towed out but didn’t disturb the drive through area. The green space was the main area that was effected. I will monitor the issue to ensure that compaction of the subgrade is not adversely compromise.
Pavement-Curb Construction Partial 11/30/2022
Misc
Informational
11/30/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Eastside. Blankets where used to cover curbs due to the overnight drop in temperatures.
Piers/Caissons Inspection - Commercial Partial 12/2/2022 12/2/2022 12/02/2022
Miscellaneous Correction
Corrective Action Required
11/30/2022
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 3 light pole bases to pour middle two closest to building and S most base. No ground rods still
Piers/Caissons Inspection - Commercial Partial 12/2/2022 12/02/2022
Miscellaneous Correction
Corrective Action Required
12/02/2022
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 2 light pole bases to pour. middle N closest to building and S most base. No ground rods still
Commercial Curb Inspection Partial 12/02/2022
Misc
Informational
11/30/2022
08/31/22 Wednesday JMJ ( Precision Construction ) Curbs were installed at 1:00PM. 11/29/22 Tuesday JMJ ( Remuas Concrete ) Contractor continued curbs forms and materials around building and for project. Alpha & Omega testing lab will do the third party inspections for parking lot. Contractor will call if concrete schedule pour is moved up from tomorrow morning. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor continued pour curbs on the Westside building. The concrete truck gut stuck and had to be towed out but didn’t disturb the drive through area. The green space was the main area that was effected. I will monitor the issue to ensure that compaction of the subgrade is not adversely compromise. 12/02/22 Friday JMJ ( Remuas Concrete ) Contractor pouring the eyebrows for the inner curb on the Northside.
Pavement-Stabilized Subgrade Partial 12/02/2022
Misc
Informational
12/02/2022
12/02/22 Friday JMJ Contractor removing unstable soil and replacing it with shotrock and MOD type 5, clean soil. Problem areas drive through outer curb line towards centerline and the outer edge to the Eastside of along the curb line and other areas with divots & piles of spoils.
Pavement-Stabilized Subgrade Partial 12/05/2022
Misc
Informational
12/02/2022
12/02/22 Friday JMJ Contractor removing unstable soil and replacing it with shotrock and MOD type 5, clean soil. Problem areas drive through outer curb line towards centerline and the outer edge to the Eastside of along the curb line and other areas with divots & piles of spoils.
Misc
Informational
12/05/2022
12/05/22 Monday JMJ ( Complete Construction ) Worked to stabilize the subgrade over the weekend for part of drive through and the Eastside of project. Shot rock and AB3/MODOT 5 was used to stabilization.
Site Visit Partial 12/05/2022
Misc
Informational
10/06/2022
10/06/22 Thursday JMJ ( Parkway Construction ) Grading and hauling away of spoils. Third party was onsite to collect concrete cylinders Alpha-Omega Geotech for building pads.
Misc
Informational
12/05/2022
12/05/22 Monday JMJ ( Complete Excavation/ Remas Concrete ) Complete Excavation continues to work on site to stabilize subgrade in cold weather climate. Remas Concrete building forms for curbs. Viewed dump truck hauling approximately 21 tons of gravel roll across a small portion of the project , and the subgrade appeared to be stable.
Pavement-Curb Construction Partial 12/06/2022
Misc
Informational
11/30/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project.
Pavement-Curb Construction Partial 12/07/2022
Misc
Informational
12/06/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight.
Pavement-Curb Construction Partial 12/09/2022
Misc
Informational
12/07/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight. 12/09/22 Friday JMJ ( Remas Concrete ) Contractor pouring foundation platform ( footing were poured already) for dumpster area and pouring circumference curbs on the drive through on the Northside of building.

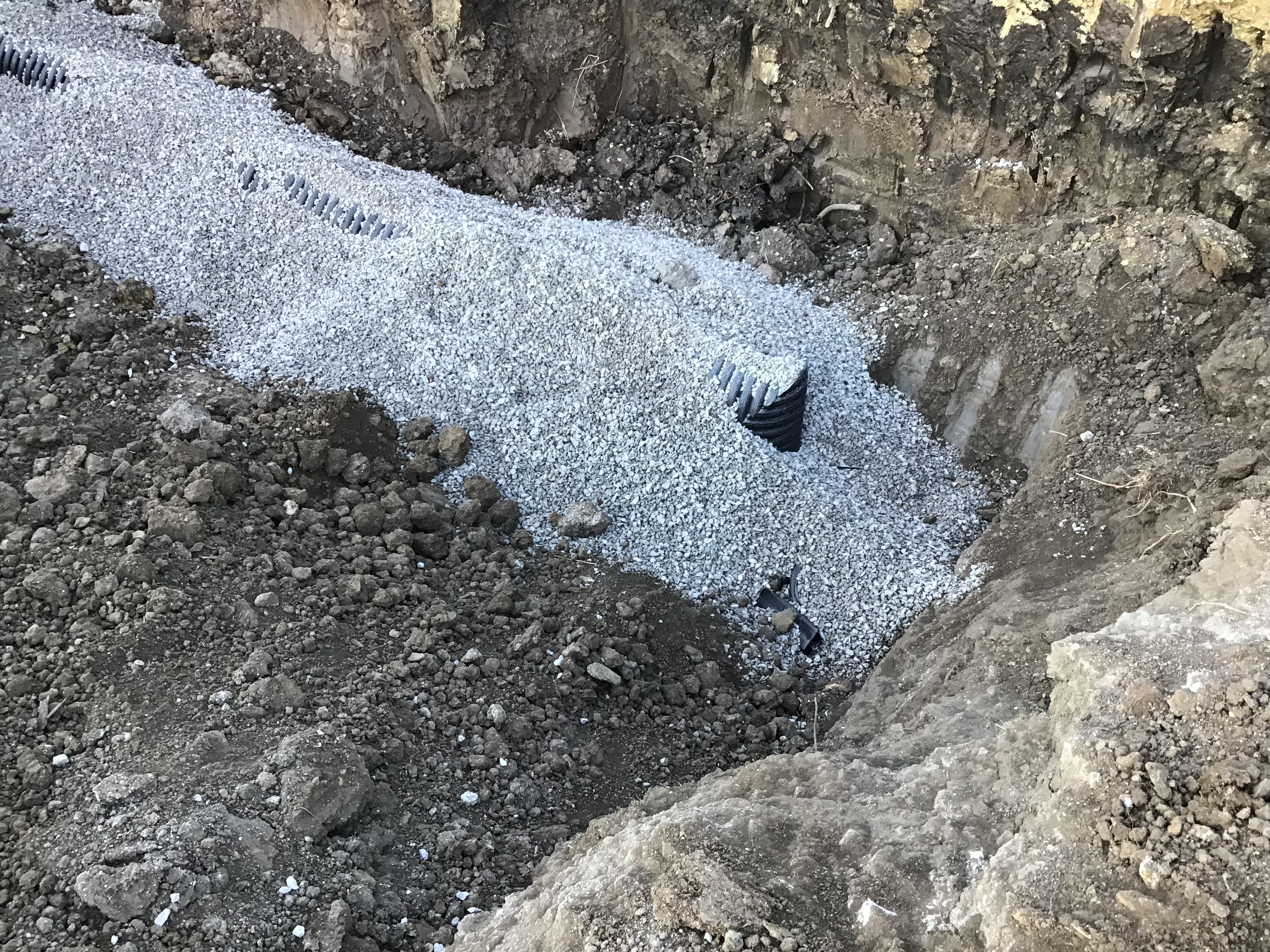

Grading/Excavation/Fill Inspection Partial 12/12/2022
Misc
Corrective Action Required
12/12/2022
12/12/22 Monday JMJ ( Complete Excavation/ Remus Conrete) Contractor was grading parking lot area for gravel and Geogrid for stabilization. Complete Excavation during grading foun a bust in the circumference of the new curbs poured on the Southeast side.
Pavement-Stabilized Subgrade Partial 12/12/2022
Misc
Informational
12/05/2022
12/02/22 Friday JMJ Contractor removing unstable soil and replacing it with shotrock and MOD type 5, clean soil. Problem areas drive through outer curb line towards centerline and the outer edge to the Eastside of along the curb line and other areas with divots & piles of spoils.
Misc
Informational
12/05/2022
12/05/22 Monday JMJ ( Complete Construction ) Worked to stabilize the subgrade over the weekend for part of drive through and the Eastside of project. Shot rock and AB3/MODOT 5 was used to stabilization.
Misc
Informational
12/12/2022
12/03/22 Saturday JMJ ( Complete Excavation ) Observing that the contractor removes soil that has been adversely effected by the inclement seasonal weather and replace with materials that can maintain a quality subgrade. Contractor is using shot rock and AB3/MODOT 5 to obtain a stable ground to possibly pour concrete and lay asphalt throughout the project. City inspector and the third party Alpha & Omega testing will witness a proof roll at some future date. See photos of stabilization efforts on this date in Documents and Images.
Hood/Duct Inspection Partial 12/13/2022 12/13/2022 12/13/2022
Informational
12/13/2022
GREASE DUCTS LIGHT TEST-OK TO FIRE-WRAP
Hood/Duct Inspection Partial 12/14/2022 12/14/2022 12/14/2022
Misc
Corrective Action Required
12/14/2022
3 GREASE DUCTS: -LIGHT TEST-OK TO FIRE-WRAP -1ST LAYER WRAP OK
In-wall Inspection Failed 12/16/2022 12/16/2022 12/16/2022
Miscellaneous Correction
Corrective Action Required
11/17/2022
-Protect all dwv within 1.25" to face of framing min 2" above plates -Provide midpoint strap at 2" and smaller dwv -Missing H2.5s at back electrical area -Provide H2.5s for both plies of double trusses -Provide truss plans for inspection -Provide anchor bolts within 12" of plate breaks at dining- 2 locations -Address top plates overlapped less than 48" at dining -Solid block and nail horizontal sheathing seams -Nail exterior corner studs at dining -Land mc near mechanical area and restrooms
In-wall Inspection Failed 12/20/2022 12/20/2022 12/20/2022
Miscellaneous Correction
Corrective Action Required
12/16/2022
-Protect all dwv within 1.25" to face of framing min 2" above plates -Provide midpoint strap at 2" and smaller dwv -Missing H2.5s at back electrical area -Provide H2.5s for both plies of double trusses -Provide truss plans for inspection -Provide anchor bolts within 12" of plate breaks at dining- 2 locations -Address top plates overlapped less than 48" at dining -Solid block and nail horizontal sheathing seams -Nail exterior corner studs at dining -Land mc near mechanical area and restrooms
Pavement-Stabilized Subgrade Partial 12/21/2022
Misc
Informational
12/12/2022
12/02/22 Friday JMJ Contractor removing unstable soil and replacing it with shotrock and MOD type 5, clean soil. Problem areas drive through outer curb line towards centerline and the outer edge to the Eastside of along the curb line and other areas with divots & piles of spoils.
Misc
Informational
12/12/2022
12/05/22 Monday JMJ ( Complete Construction ) Worked to stabilize the subgrade over the weekend for part of drive through and the Eastside of project. Shot rock and AB3/MODOT 5 was used to stabilization.
Misc
Informational
12/12/2022
12/03/22 Saturday JMJ ( Complete Excavation ) Observing that the contractor removes soil that has been adversely effected by the inclement seasonal weather and replace with materials that can maintain a quality subgrade. Contractor is using shot rock and AB3/MODOT 5 to obtain a stable ground to possibly pour concrete and lay asphalt throughout the project. City inspector and the third party Alpha & Omega testing will witness a proof roll at some future date. See photos of stabilization efforts on this date in Documents and Images. 12/21/22 Wednesday JMJ ( Complete Excavation ) Contractor continued to work the subgrade for stabilization project also blankets were placed on the drive-through. Contractor has set a soft schedule to pour concrete on the 27th of December. Contractor will call the inspector out to inspect the surface to ensure condition are right for parking lot construction.
In-wall Inspection Partial 12/28/2022 12/28/2022 12/28/2022
Miscellaneous Correction
Corrective Action Required
12/20/2022
-Provide H2.5s for both plies of double trusses-missing at storage area -Provide truss plans for inspection-Provide all lateral bracing per plans -Provide anchor bolts within 12" of plate breaks at dining- see kitchen area -Solid block and nail horizontal sheathing seams-dining room exterior corner **OK FOR ROCK ON WALLS-DO NOT COVER INSPECITON ITEMS
Hood/Duct Inspection Passed 12/28/2022
Misc
Corrective Action Required
12/14/2022
3 GREASE DUCTS: -LIGHT TEST-OK TO FIRE-WRAP -1ST LAYER WRAP OK -2ND LAYER WRAP OK
Site Visit Partial 12/28/2022
Misc
Informational
12/05/2022
10/06/22 Thursday JMJ ( Parkway Construction ) Grading and hauling away of spoils. Third party was onsite to collect concrete cylinders Alpha-Omega Geotech for building pads.
Misc
Informational
12/05/2022
12/05/22 Monday JMJ ( Complete Excavation/ Remas Concrete ) Complete Excavation continues to work on site to stabilize subgrade in cold weather climate. Remas Concrete building forms for curbs. Viewed dump truck hauling approximately 21 tons of gravel roll across a small portion of the project , and the subgrade appeared to be stable. 12/28/22 Wednesday JMJ Contractor will be pouring drive through @ 7:00AM tomorrow. Contractor has complete covered drive through and attempt to cover parking lot ( covers blow-off ). The contractor will grade, scrape and remove snow or ice from surface.
Pavement-Aggregate Base Partial 12/29/2022
Misc
Informational
12/29/2022

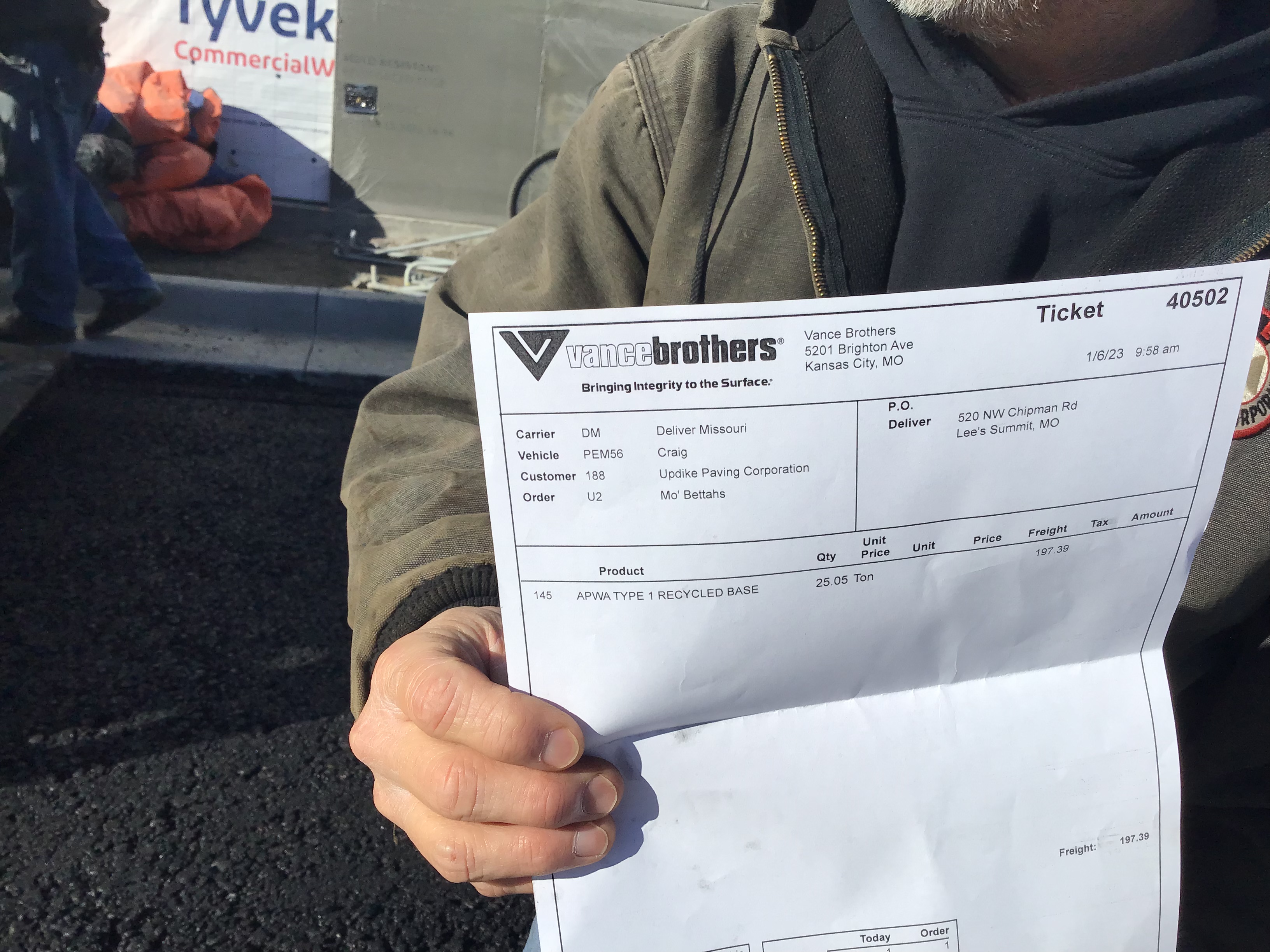

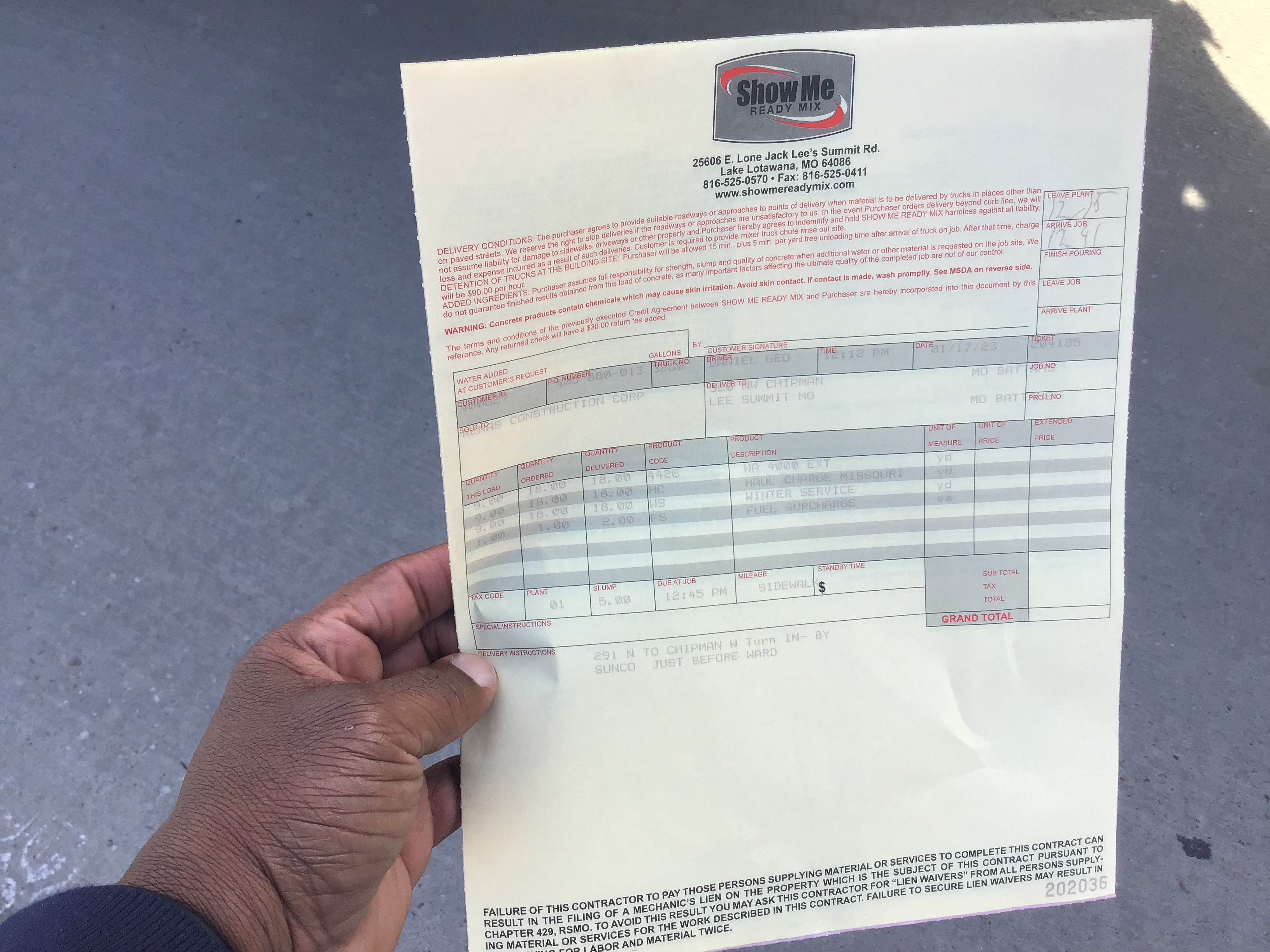

12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete.
Pavement-Aggregate Base Partial 12/29/2022
Misc
Informational
12/29/2022
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM
In-wall Inspection Passed 12/30/2022 12/30/2022 12/30/2022
Miscellaneous Correction
Resolved
12/30/2022
-Provide H2.5s for both plies of double trusses-missing at storage area -Provide truss plans for inspection-Provide all lateral bracing per plans -Provide anchor bolts within 12" of plate breaks at dining- see kitchen area -Solid block and nail horizontal sheathing seams-dining room exterior corner **OK FOR ROCK ON WALLS-DO NOT COVER INSPECITON ITEMS
Pavement-Aggregate Base Partial 12/30/2022
Misc
Informational
12/29/2022
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM 12/30/22 Friday JMJ ( Alpha-Omega GeoTech ) Third party testing observed the subgrade was stable ( after regrading ). Alpha-Omega GeoTech collected cylinders strength break samples. Contractor will be work pouring concrete until at least 5:30PM today.
Site Visit Partial 01/03/2023
Misc
Informational
12/28/2022
10/06/22 Thursday JMJ ( Parkway Construction ) Grading and hauling away of spoils. Third party was onsite to collect concrete cylinders Alpha-Omega Geotech for building pads.
Misc
Informational
12/28/2022
12/05/22 Monday JMJ ( Complete Excavation/ Remas Concrete ) Complete Excavation continues to work on site to stabilize subgrade in cold weather climate. Remas Concrete building forms for curbs. Viewed dump truck hauling approximately 21 tons of gravel roll across a small portion of the project , and the subgrade appeared to be stable. 12/28/22 Wednesday JMJ Contractor will be pouring drive through @ 7:00AM tomorrow. Contractor has complete covered drive through and attempt to cover parking lot ( covers blow-off ). The contractor will grade, scrape and remove snow or ice from surface. 01/03/23 Tuesday JMJ Contractor work to pump water off the site from electrical sump pumps. I will evaluate in the upcoming days the integrality of subgrade for covering with asphalt and concrete.
Pavement-Aggregate Base Partial 01/04/2023
Misc
Informational
12/30/2022
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM 12/30/22 Friday JMJ ( Alpha-Omega GeoTech ) Third party testing observed the subgrade was stable ( after regrading ). Alpha-Omega GeoTech collected cylinders strength break samples. Contractor will be work pouring concrete until at least 5:30PM today. 01/04/23 Wednesday JMJ ( Parkway Construction Co.-tony, Sub Contractor Complete Excavating Inc. CEI ) Talked with contractors and told them that we will needed the developer to approve the pouring of the approach. We have no way to redo a proof roll because of the depth of area that needs concrete. I witness sub contractor removing water muck soil and getting down to what appeared to be solid subgrade and reinstalling aggregate gravel and compacting with light track hole equipment.
Pavement-Aggregate Base Partial 01/05/2023
Misc
Informational
01/04/2023
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM 12/30/22 Friday JMJ ( Alpha-Omega GeoTech ) Third party testing observed the subgrade was stable ( after regrading ). Alpha-Omega GeoTech collected cylinders strength break samples. Contractor will be work pouring concrete until at least 5:30PM today. 01/04/23 Wednesday JMJ ( Parkway Construction Co.-tony, Sub Contractor Complete Excavating Inc. CEI ) Talked with contractors and told them that we will needed the developer to approve the pouring of the approach. We have no way to redo a proof roll because of the depth of area that needs concrete. I witness sub contractor removing water muck soil and getting down to what appeared to be solid subgrade and reinstalling aggregate gravel and compacting with light track hole equipment. 01/05/23 Thursday JMJ ( Remas Concrete ) Contractor poured concrete approach, and connected dumpster area and drive-through on the Northside from boom truck. Inspector observed that the grounds appeared to be stable. ( See notes from yesterday about approval of today’s pour. )
Pavement-Aggregate Base Partial 01/06/2023
Misc
Informational
01/05/2023
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM 12/30/22 Friday JMJ ( Alpha-Omega GeoTech ) Third party testing observed the subgrade was stable ( after regrading ). Alpha-Omega GeoTech collected cylinders strength break samples. Contractor will be work pouring concrete until at least 5:30PM today. 01/04/23 Wednesday JMJ ( Parkway Construction Co.-Tony NiBlack, Sub Contractor Complete Excavating Inc. CEI ) Talked with contractors and told them that we will needed the developer to approve the pouring of the approach. We have no way to redo a proof roll because of the depth of area that needs concrete. I witness sub contractor removing water muck soil and getting down to what appeared to be solid subgrade and reinstalling aggregate gravel and compacting with light track hole equipment. 01/05/23 Thursday JMJ ( Remas Concrete ) Contractor poured concrete approach, and connected dumpster area and drive-through on the Northside from boom truck. Inspector observed that the grounds appeared to be stable. ( See notes from yesterday about approval of today’s pour. ) 01/06/23 Friday JMJ ( “GC” Parkway Construction Co.- Tony NiBlack, UpDiKe- Shawn Updike, ) Contractor began laying asphalt around 10:40AM Temperature 35 deg. Contractor ( Parkway Construction Co. ) wants to lay base and surface even thought the high is 47 degrees by 3:00PM. This is below the the temperature for City specifications they well. Contractor understand this is their responsibility if issues arise because of their lack of compliance to installation of asphalt parkways and drive areas. Type -1 for base and Type-3 for surface.
Pavement-Aggregate Base Partial 01/06/2023
Misc
Informational
01/06/2023
12/29/22 Thursday JMJ ( Alpha-Omega GeoTech ) Third party testing ( Alpha-Omega did not any problem area in drive-through subgrade surface that concrete will be poured. Alpha Omega collecting cylinders for concrete. Started pouring and buggy transferring concrete to drive-through. Projecting approximately 80 yards of concrete. Contractor was still pour concrete around 4:50PM 12/30/22 Friday JMJ ( Alpha-Omega GeoTech ) Third party testing observed the subgrade was stable ( after regrading ). Alpha-Omega GeoTech collected cylinders strength break samples. Contractor will be work pouring concrete until at least 5:30PM today. 01/04/23 Wednesday JMJ ( Parkway Construction Co.-Tony NiBlack, Sub Contractor Complete Excavating Inc. CEI ) Talked with contractors and told them that we will needed the developer to approve the pouring of the approach. We have no way to redo a proof roll because of the depth of area that needs concrete. I witness sub contractor removing water muck soil and getting down to what appeared to be solid subgrade and reinstalling aggregate gravel and compacting with light track hole equipment. 01/05/23 Thursday JMJ ( Remas Concrete ) Contractor poured concrete approach, and connected dumpster area and drive-through on the Northside from boom truck. Inspector observed that the grounds appeared to be stable. ( See notes from yesterday about approval of today’s pour. ) 01/06/23 Friday JMJ ( “GC” Parkway Construction Co.- Tony NiBlack, UpDiKe- Shawn Updike, ) Contractor began laying asphalt around 10:40AM Temperature 35 deg. Contractor ( Parkway Construction Co. ) wants to lay base and surface even thought the high is 47 degrees by 3:00PM. This is below the the temperature for City specifications they well. Contractor understand this is their responsibility if issues arise because of their lack of compliance to installation of asphalt parkways and drive areas. Type -1 for base and Type-3 for surface. Sub- contractor UpDike will have laid approximately 225 tons of base asphalt aggregate. Contractor only completed the base asphalt because the conditions of few areas subgrade appeared to be less than favorable. Contractor will allow base to settle and lay surface asphalt at a later date when conditions are better. If any area need to be cut-out are redone it will be done then.
Sidewalk Inspection Partial 1/11/2023 1/11/2023 01/11/2023
Misc
Informational
01/11/2023

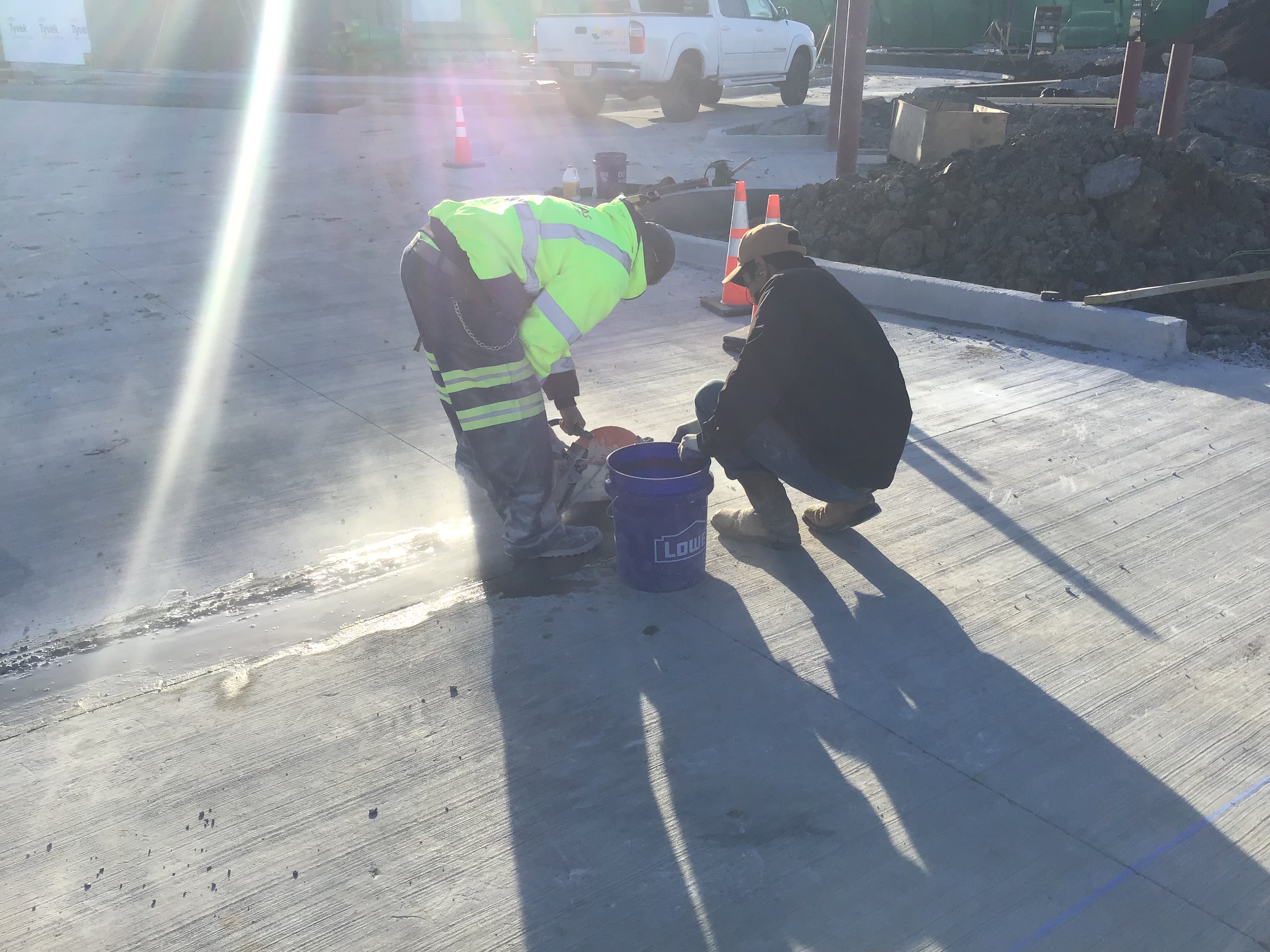

01/11/23 Wednesday JMJ ( Remas Concrete ) Contractor pouring sidewalks and ADA ramps on the Eastside of building.
Sidewalk Inspection Partial 1/12/2023 1/12/2023 01/12/2023
Misc
Informational
01/11/2023
01/11/23 Wednesday JMJ ( Remas Concrete ) Contractor pouring sidewalks and ADA ramps on the Eastside of building. 01/12/23 Thursday JMJ ( Remas Concrete ) Meet with contractor about the future installation of public sidewalks and the demolition of the approach and to (re)pour to City specifications. The work will likely be. done Monday 01/16/23.
Piers/Caissons Inspection - Commercial Not Ready 1/13/2023 1/13/2023 01/13/2023
Miscellaneous Correction
Corrective Action Required
12/02/2022
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 2 light pole bases to pour. middle N closest to building and S most base. No ground rods still 1/13/23-NOT READY. COMPLETE ELECTRICAL, REMOVE ANY WATER OR LOOSE DEBRIS FROM PIERS, CONCRETE IS NOT ALLOWED TO BE POURED ON FROZEN SOIL
Pavement-Surface Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/16/2023
01/16/23 Monday JMJ ( Remas ) Contractor saw cutting approach that need to be removed to meet specifications requirements for public sidewalks and drives. I will check forms tomorrow.
Piers/Caissons Inspection - Commercial Not Ready 1/17/2023 1/17/2023 01/17/2023
Miscellaneous Correction
Corrective Action Required
01/13/2023
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 2 light pole bases to pour. middle N closest to building and S most base. No ground rods still 1/13/23-NOT READY. COMPLETE ELECTRICAL, REMOVE ANY WATER OR LOOSE DEBRIS FROM PIERS, CONCRETE IS NOT ALLOWED TO BE POURED ON FROZEN SOIL 1/17/23- NOT READY. PIER DEPTH TO BE 6' BELOW GRADE PER PREVIOUSLY REFERECNCED DETAIL ON ES101. REMOVE LOOSE DEBRIS, SUPPORT REBAR 3" FROM SIDE OF SAUNA TUBES AND COMPLETE PER DETAIL
Public Curb Inspection Partial 01/17/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday ( Remas ) Contractor will be forming curbs that were removed and re-installed along the approach area on both sides.
Sidewalk Inspection Partial 01/17/2023
Misc
Informational
01/12/2023
01/11/23 Wednesday JMJ ( Remas Concrete ) Contractor pouring sidewalks and ADA ramps on the Eastside of building. 01/12/23 Thursday JMJ ( Remas Concrete ) Meet with contractor about the future installation of public sidewalks and the demolition of the approach and to (re)pour to City specifications. The work will likely be. done Monday 01/16/23. 01/17/23 Tuesday JMJ ( Remas Concrete ) Contractor poured sidewalks and approach throughout sidewalk path.
Erosion Control Inspection Partial 1/18/2023 1/18/2023 01/18/2023
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Piers/Caissons Inspection - Commercial Not Ready 1/20/2023 (8:00) 1/20/2023 01/20/2023
Miscellaneous Correction
Corrective Action Required
01/17/2023
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 2 light pole bases to pour. middle N closest to building and S most base. No ground rods still 1/13/23-NOT READY. COMPLETE ELECTRICAL, REMOVE ANY WATER OR LOOSE DEBRIS FROM PIERS, CONCRETE IS NOT ALLOWED TO BE POURED ON FROZEN SOIL 1/17/23- NOT READY. PIER DEPTH TO BE 6' BELOW GRADE PER PREVIOUSLY REFERECNCED DETAIL ON ES101. REMOVE LOOSE DEBRIS, SUPPORT REBAR 3" FROM SIDE OF SAUNA TUBES AND COMPLETE PER DETAIL 1/20/23-NOT READY. PLEASE REFER TO THE DETAILS ON THE APPROVED PLANS AND COMPLETE CORRECTIONS FROM ALL PREVIOUS FAILED INSPECTIONS
Sidewalk Inspection Failed 1/20/2023 1/20/2023 01/20/2023
Misc
Corrective Action Required
01/20/2023
01/20/23 Friday JMJ ( Remas ) ADA ramps on the and the walkway through the approach failed. So, the West ramp, East ramp, walkway between need to be torn out and re-installed to specifications.
Sidewalk Inspection Partial 1/20/2023 1/20/2023 01/20/2023
Misc
Corrective Action Required
01/20/2023
01/20/23 Friday JMJ ( Remas ) ADA ramps on the and the walkway through the approach failed. So, the West ramp, East ramp, walkway between need to be torn out and re-installed to specifications.
Misc
Informational
01/20/2023
01/20/23 Friday JMJ ( Remas ) Sidewalks passed inspection Public and Private.
Electrical Service Inspection Passed 01/30/2023
Underground Electrical Inspection - Commercial Passed 1/30/2023 1/30/2023 01/30/2023
Misc
Informational
11/22/2022
PARTIAL PASS ELECTRICAL CONDUIT WEST TRANSFORMER ABOUT 60' EAST TO GATE - IT CONDUIT FRONT OF BUILDING TO SIDEWALK OK TO COVER - - 11/22/22 CONDUIT FOR (7) LIGHT POLE BASES OK TO BACKFILL -
Pavement-Curb Construction Partial 1/17/2023 1/17/2023 02/02/2023
Misc
Informational
12/09/2022
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight. 12/09/22 Friday JMJ ( Remas Concrete ) Contractor pouring foundation platform ( footing were poured already) for dumpster area and pouring circumference curbs on the drive through on the Northside of building.
Misc
Informational
02/02/2023
02/02/23 Thursday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor removed curbs and drive-through pavement that was installed by ( Remas Concrete ) yesterday. Contractor poured curbs for drive-through .
Above Ceiling Inspection Partial 2/3/2023 2/3/2023 02/03/2023
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/03/2023
-Hard lids at bathrooms ok
Pavement-Curb Construction Partial 2/3/2023 2/3/2023 02/03/2023
Misc
Informational
02/02/2023

11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight. 12/09/22 Friday JMJ ( Remas Concrete ) Contractor pouring foundation platform ( footing were poured already) for dumpster area and pouring circumference curbs on the drive through on the Northside of building.
Misc
Informational
02/02/2023
02/02/23 Thursday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor removed curbs and drive-through pavement that was installed by ( Remas Concrete ) yesterday. Contractor poured curbs for drive-through. 02/03/23 Friday JMJ ( Al Muehlberger Concrete Company, LLC, Remas Concrete ) Contractors continues to remove curbs, sidewalks, and concrete pavement not meeting City specification and for utilities that need to be installed.
Pavement-Curb Construction Partial 2/4/2023 2/4/2023 02/04/2023
Misc
Informational
02/03/2023
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight. 12/09/22 Friday JMJ ( Remas Concrete ) Contractor pouring foundation platform ( footing were poured already) for dumpster area and pouring circumference curbs on the drive through on the Northside of building.
Misc
Informational
02/03/2023
02/02/23 Thursday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor removed curbs and drive-through pavement that was installed by ( Remas Concrete ) yesterday. Contractor poured curbs for drive-through. 02/03/23 Friday JMJ ( Al Muehlberger Concrete Company, LLC, Remas Concrete ) Contractors continues to remove curbs, sidewalks, and concrete pavement not meeting City specification and for utilities that need to be installed. 02/04/23 Saturday JMJ ( Al Muehlberger Concrete Company, LLC/ Remas Concrete Co. ) Contractor had schedule to remove ADA ramps and approach today, but since Al Muhlberger Concrete Company did not work today who will be replacing curbs and pavement. Remas Concrete Co. didn't remove public sidewalks and approach. Al Muehlberger will be back Moday to continue work. Inspector took picture of demo Pavement-Curbs on project. Talked with site manager about notifying me when plans change about shceduled work.
Above Ceiling Inspection Partial 2/6/2023 2/6/2023 02/06/2023
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/03/2023
-Hard lids at bathrooms, kitchen and dining ok
Pavement-Curb Construction Partial 2/6/2023 2/6/2023 02/06/2023
Misc
Informational
02/04/2023
11/16/22 Wednesday JMJ ( Remus Concrete ) Contractor poured the curbs at the South end of project approximately 10yards. Blankets are own site to cover curbs. 11/21/22 Monday JMJ ( Remuas Concrete ) Inspected forms and materials for curbs for drive through. Alpha & Omega testing did the third party inspection on the subgrade and will test concrete poured for the project. Concrete for drive through curbs will be poured around 1:00PM. Contractor did not begin curb pour until 3:00PM. Blankets are on site to cover curbs. 11/30/22 Wednesday JMJ ( Remuas Concrete ) Contractor poured curbs around building starting on the Westside. Blankets where used to cover curbs due to the overnight drop in temperatures. 12/06/22 Tuesday JMJ ( Remas Concrete ) Contractor pouring curbs on the Eastside of project. 12/07/22 Wednesday JMJ (Contractor- Remas Concrete ) Contractor began pouring outside curb on the Westside ( drive through ), curb will cured and covered. Inclement rainfall excepted overnight. 12/09/22 Friday JMJ ( Remas Concrete ) Contractor pouring foundation platform ( footing were poured already) for dumpster area and pouring circumference curbs on the drive through on the Northside of building.
Misc
Informational
02/04/2023
02/02/23 Thursday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor removed curbs and drive-through pavement that was installed by ( Remas Concrete ) yesterday. Contractor poured curbs for drive-through. 02/03/23 Friday JMJ ( Al Muehlberger Concrete Company, LLC, Remas Concrete ) Contractors continues to remove curbs, sidewalks, and concrete pavement not meeting City specification and for utilities that need to be installed. 02/04/23 Saturday JMJ ( Al Muehlberger Concrete Company, LLC/ Remas Concrete Co. ) Contractor had schedule to remove ADA ramps and approach today, but since Al Muhlberger Concrete Company did not work today who will be replacing curbs and pavement. Remas Concrete Co. didn't remove public sidewalks and approach. Al Muehlberger will be back Moday to continue work. Inspector took picture of demo Pavement-Curbs on project. Talked with site manager about notifying me when plans change about scheduled work. 02/06/23 Monday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor poured curbs on the Eastside of the project ,and curbs & pavement through drive-through.
Miscellaneous Inspection Partial 2/6/2023 2/6/2023 02/06/2023
Misc
Informational
02/06/2023
02/06/23 Monday JMJ ( Kingdom Stone ) Contractor constructing dumpster walls.
Piers/Caissons Inspection - Commercial Partial 02/07/2023
Miscellaneous Correction
Resolved
02/07/2023
- 11/22/22 LIGHT POLE BASES NO DRIVEN GROUND RODS PROVIDE REBAR CAGES PER CITY APPROVED PLANS SHEET ES101 12/2/22 Passed 2 light pole bases to pour. middle N closest to building and S most base. No ground rods still 1/13/23-NOT READY. COMPLETE ELECTRICAL, REMOVE ANY WATER OR LOOSE DEBRIS FROM PIERS, CONCRETE IS NOT ALLOWED TO BE POURED ON FROZEN SOIL 1/17/23- NOT READY. PIER DEPTH TO BE 6' BELOW GRADE PER PREVIOUSLY REFERECNCED DETAIL ON ES101. REMOVE LOOSE DEBRIS, SUPPORT REBAR 3" FROM SIDE OF SAUNA TUBES AND COMPLETE PER DETAIL 1/20/23-NOT READY. PLEASE REFER TO THE DETAILS ON THE APPROVED PLANS AND COMPLETE CORRECTIONS FROM ALL PREVIOUS FAILED INSPECTIONS
Misc
Corrective Action Required
02/07/2023
-Pier for menu board ok Piers for light pole bases ok to pour -Leave ground rod and connection exposed for inspection when installed
Gas Service Inspection - Commercial Passed 2/7/2023 2/7/2023 02/07/2023
Miscellaneous Inspection Partial 2/8/2023 2/8/2023 02/08/2023
Misc
Informational
02/08/2023
02/08/23 Thursday JMJ ( Al Muehlberger Concrete Company, LLC ) (913) 927-1624 Contract poured curb and patio area. ( Branchout Co.) Grading and preparing grounds for vegetation.
Sidewalk Inspection Partial 2/10/2023 2/10/2023 02/10/2023
Misc
Corrective Action Required
01/20/2023
01/20/23 Friday JMJ ( Remas ) ADA ramps on the and the walkway through the approach failed. So, the West ramp, East ramp, walkway between need to be torn out and re-installed to specifications.
Misc
Informational
01/20/2023
01/20/23 Friday JMJ ( Remas ) Sidewalks passed inspection Public and Private. 02/10/23 Friday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor ( Al Muehlberger ) is correcting the failed ADA ramps and drive approach that ( Remas ) installed incorrectly. Concrete was demo by Al Muehlberger. Contractor plans to pour back ADA ramps, sidewalks, and drive approach.
Sidewalk Inspection Partial 2/13/2023 2/13/2023 02/13/2023
Misc
Corrective Action Required
02/10/2023
01/20/23 Friday JMJ ( Remas ) ADA ramps on the and the walkway through the approach failed. So, the West ramp, East ramp, walkway between need to be torn out and re-installed to specifications.
Misc
Informational
02/10/2023
01/20/23 Friday JMJ ( Remas ) Sidewalks passed inspection Public and Private. 02/10/23 Friday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor ( Al Muehlberger ) is correcting the failed ADA ramps and drive approach that ( Remas ) installed incorrectly. Concrete was demo by Al Muehlberger. Contractor plans to pour back ADA ramps, sidewalks, and drive approach. 02/13/23 Monday JMJ ( Al Muehlberger Concrete Company, LLC ) Contractor will be pouring the sidewalks, drive approach, and ADA ramp. Contractor began pouring concrete around 1:00PM KCMMB 4K 4000 mix. ( Contractor poured patio on the Northwest side of building ).
Erosion Control Inspection Residential Partial 2/14/2023 2/14/2023 02/14/2023
Misc
Informational
02/14/2023
02/14/23 Tuesday JMJ Contractor will need to do a light clean-up of private street, some soil has spoiled over on to the street. Contractor will address the issue later the week when the weather clears up, so as not to smear dirt into mud on street because of rainy condition.
Above Ceiling Inspection Failed 2/17/2023 2/17/2023 02/17/2023
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/06/2023
-Hard lids at bathrooms, kitchen and dining ok -Electrical room ok
Misc
Corrective Action Required
02/17/2023
-Remove tile in kitchen and mechanical for inspeftion
Above Ceiling Inspection Passed 2/21/2023 2/21/2023 02/21/2023
THE FOLLOWING AREAS ARE APPROVED
Resolved
02/21/2023
-Hard lids at bathrooms, kitchen and dining ok -Electrical room ok
Misc
Resolved
02/21/2023
-Remove tile in kitchen and mechanical for inspeftion
Pavement-Surface Partial 2/6/2023 2/6/2023 02/21/2023
Misc
Informational
01/16/2023
01/16/23 Monday JMJ ( Remas ) Contractor saw cutting approach that need to be removed to meet specifications requirements for public sidewalks and drives. I will check forms tomorrow. ( See public sidewalk )
Misc
Informational
02/21/2023
02/21/23 Tuesday JMJ ( Updike Paving Corporation ) Contractor laid APWA Type # Recycled Surface for asphalt on project.
Alternate Protection Systems Inspection Passed 2/23/2023 02/23/2023
Miscellaneous Inspection Partial 2/27/2023 2/27/2023 02/27/2023
Misc
Informational
02/08/2023
02/06/23 Monday JMJ ( Kingdom Stone ) Contractor constructing dumpster walls.
All Rough Inspection - Commercial Passed 2/27/2023 2/27/2023 02/27/2023
ESC - (Vegetation/Ground Cover) Partial 2/28/2023 2/28/2023 02/28/2023
Misc
Informational
02/28/2023
02/28/23 Tuesday JMJ Contractor is working on grading of parkway and grounds.
ESC - (Vegetation/Ground Cover) Partial 3/1/2023 3/1/2023 03/01/2023
Misc
Informational
02/28/2023
02/28/23 Tuesday JMJ Contractor is working on grading of parkway and grounds. 03/01/23 Wednesday JMJ ( Branched Out ) Contractor began laying sod, mulch, and, bushes on property. Commercial Final: MO' BETTAHAS tomorrow @ 3:00PM.
Occupancy Inspection - Water Utilities Passed 3/2/2023 3/6/2023 03/02/2023
Occupancy Inspection - Planning Temporary C of O 3/2/2023 3/6/2023 03/02/2023
Miscellaneous Correction
Corrective Action Required
03/02/2023
Complete landscaping per approved plan.
Misc
Corrective Action Required
03/02/2023
Complete painting/building exterior per approved plan.
Misc
Corrective Action Required
03/02/2023
Clear debris from site upon completion of construction.
Occupancy Inspection - Codes Commercial Failed 3/2/2023 3/2/2023 03/02/2023
Miscellaneous Correction
Corrective Action Required
03/02/2023
-Obtain approval from Jackson County Health Department -Complete corrections for all other departments -Remove all trash from rooftop -Label RTUs and rooftop equipment -Grab bar height to be 33"-36" at restrooms -Provide accessible restroom signage -Paint all exterior gas lines with corrosion resistant paint -Provide air gap at all fixture drains compliant with 2018 IPC table 608.16.1 -Open hand holes at light pole bases for inspection
ESC - (Vegetation/Ground Cover) Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
03/01/2023
02/28/23 Tuesday JMJ Contractor is working on grading of parkway and grounds. 03/01/23 Wednesday JMJ ( Branched Out ) Contractor began laying sod, mulch, and, bushes on property. Commercial Final: MO' BETTAHAS tomorrow @ 3:00PM. 03/03/23 Friday JMJ ( Branched Out ) Contractor appears to have met the requirements for vegetation/ground cover, TCO will be given by the building inspector.
Erosion Control Inspection Residential Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
03/03/2023
03/03/23 Friday JMJ Sodding & vegetation was installed yesterday and erosion control from this appears to be functioning.
Footing Inspection - Commercial Passed 03/06/2023
Miscellaneous Correction
Resolved
03/06/2023
-(4) FOOTINGS FOR CANOPY SW CORNER OF BLDG (3) GRADE BEAMS IN BLDG SLAB OK TO POUR - -FOOTING AT DUMPSTER ENCLOSURE OK PROVIDE # 3 TIES @ 2" OC ON TOP OF COLUMNS PER PLAN
Occupancy Inspection - Codes Commercial Failed 3/6/2023 3/6/2023 03/06/2023
Miscellaneous Correction
Corrective Action Required
03/02/2023
-Complete corrections for all other departments -Label RTUs and rooftop equipment
Occupancy Inspection - Engineering Temporary C of O 3/2/2023 3/6/2023 03/06/2023
Misc
Informational
03/06/2023
Temporary Occupancy is given. Needed for Final Occupancy 1. Remove dumpster.
Pavement-Surface Passed 03/06/2023
Misc
Informational
02/21/2023
01/16/23 Monday JMJ ( Remas ) Contractor saw cutting approach that need to be removed to meet specifications requirements for public sidewalks and drives. I will check forms tomorrow. ( See public sidewalk )
Misc
Informational
02/21/2023
02/21/23 Tuesday JMJ ( Updike Paving Corporation ) Contractor laid APWA Type # Recycled Surface for asphalt on project.
ESC - (Vegetation/Ground Cover) Passed 03/06/2023
Misc
Informational
03/03/2023
02/28/23 Tuesday JMJ Contractor is working on grading of parkway and grounds. 03/01/23 Wednesday JMJ ( Branched Out ) Contractor began laying sod, mulch, and, bushes on property. Commercial Final: MO' BETTAHAS tomorrow @ 3:00PM. 03/03/23 Friday JMJ ( Branched Out ) Contractor appears to have met the requirements for vegetation/ground cover, TCO will be given by the building inspector.
Occupancy Inspection - Fire Failed 3/6/2023 03/06/2023
Piers/Caissons Inspection - Commercial Passed 03/07/2023
Misc
Resolved
03/07/2023
-Pier for menu board ok Piers for light pole bases ok to pour -Leave ground rod and connection exposed for inspection when installed
Occupancy Inspection - Planning Passed 03/07/2023
Miscellaneous Correction
Corrective Action Required
03/02/2023
Complete landscaping per approved plan.
Misc
Corrective Action Required
03/02/2023
Complete painting/building exterior per approved plan.
Misc
Corrective Action Required
03/02/2023
Clear debris from site upon completion of construction.
Occupancy Inspection - Engineering Passed 3/10/2023 03/07/2023
Misc
Resolved
03/07/2023
Temporary Occupancy is given. Needed for Final Occupancy 1. Remove dumpster.
Occupancy Inspection - Fire Passed 3/2/2023 3/6/2023 03/07/2023
Occupancy Inspection - Codes Commercial Full C of O 3/7/2023 3/7/2023 03/07/2023
Miscellaneous Correction
Resolved
03/07/2023
-Complete corrections for all other departments -Codes complete
Documents & Images
Date Uploaded File Type Document Name
02/16/2022 Application Form Commercial Permit Application (original)[34]
02/16/2022 Plans Rev00_2022-01-25_MO-53LEE - Lees Summit MO_IFP set
02/16/2022 Engineer Report/Study Mo' Bettahs - Lee's Summit MO - Structural Calculations
02/16/2022 Specifications Mo' Bettahs - Lee's Summit MO - Specification Combined
02/22/2022 Letter Fire Building Plan Review
02/25/2022 Letter DS P/R Corrections Document
04/26/2022 Letter MO-53LEE - Lee's Summit MO- REVISION 02_Narrative
04/26/2022 Plans Rev02_2022-04-25_MO-53LEE - Lees Summit MO_IFP Thru REVISION 02
04/27/2022 Plans DS P_R Corrections Document_RESPONSES + drawings
04/27/2022 Letter DS P_R Corrections Document_RESPONSES
05/05/2022 Letter DS P/R Corrections Document
05/10/2022 Letter DS P_R Corrections Document46_RESPONSES
05/10/2022 Plans Rev03 - MoBettahs Lee's Summit Narrative + drawings
05/16/2022 Email jackson county approval
05/17/2022 Receipt Receipt for transaction: 2022-003513
05/31/2022 Approved Plans Approvced 2022-03-15-Mo' Bettahs - Lee's Summit MO_Civil Plans
06/03/2022 Letter License Tax Bill
06/03/2022 Letter DS Building Permit
06/15/2022 Letter Rev04 MO-53LEE - Lee's Summit MO- REVISION 04_Narrative + drawings
06/15/2022 Plans Rev04_2022-06-09_MO-53LEE - Lees Summit MO_IFC Thru REVISION 04
06/20/2022 Approved Plans approved - Rev04_2022-06-09_MO-53LEE - Lees Summit MO_IFC Thru REVISION 04
08/03/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/09/2022 Letter INSPECTION SUMMARY
08/19/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY
09/06/2022 Engineer Report/Study I53978402_MOBETTA Truss Calc 9 6 2022
09/06/2022 Drawing MOBETTA (layout) Truss 9 06 2022
09/07/2022 Approved Plans approved trusses
09/07/2022 Taps Domestic & Irrigation
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 4” Sanitary Sewer 1
09/07/2022 4” Sanitary Sewer 2
09/07/2022 Letter INSPECTION SUMMARY
09/08/2022 Taps for Meters
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Clean Out
09/08/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter INSPECTION SUMMARY
09/22/2022 Letter INSPECTION SUMMARY
09/22/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY
10/06/2022 Letter INSPECTION SUMMARY
10/25/2022 Letter INSPECTION SUMMARY
10/28/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
10/31/2022 A-1 Inlet Base with 18” HDPE Storm Pipe
10/31/2022 A-2 Inlet Base
10/31/2022 Junction Box Base
10/31/2022 Letter INSPECTION SUMMARY
11/02/2022 36” Tie-in 90 Deg Bend and Serta Tee
11/02/2022 Letter INSPECTION SUMMARY
11/02/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/16/2022 Curb Forms
11/16/2022 Concrete Tickets
11/16/2022 Concrete Poured
11/16/2022 Letter INSPECTION SUMMARY
11/16/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY
11/21/2022 Curbs for Drive Through @ MO’ Bettahs
11/21/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/29/2022 Letter INSPECTION SUMMARY
11/29/2022 Letter INSPECTION SUMMARY
11/29/2022 Ticket for curb pour
11/29/2022 Curbs #1
11/29/2022 Curbs #2
11/29/2022 Letter INSPECTION SUMMARY
11/30/2022 Dumpster Area Excavation
11/30/2022 Covered Curbs
11/30/2022 Concrete ticket
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/06/2022 Ticket for Curbs on Eastside of project
12/06/2022 Curb pour on Eastside of project 1
12/06/2022 Curb pour on Eastside of project 2
12/06/2022 Letter INSPECTION SUMMARY
12/07/2022 Outer Curbs on the Westside (drive through)
12/07/2022 Letter INSPECTION SUMMARY
12/09/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/13/2022 Letter INSPECTION SUMMARY
12/14/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/29/2022 Concrete Ticket
12/29/2022 Letter INSPECTION SUMMARY
12/29/2022 End of Concrete Pour on the Eastside of Building
12/29/2022 Last Ticket of the Day for Concrete
12/29/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
01/03/2023 4CD62F0E-CD08-4345-9ED7-49287ED2776F
01/03/2023 4DB5E170-9E3C-4967-BFB7-B337DD696959
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/05/2023 Approach for Parking and Drive-Through
01/05/2023 Letter INSPECTION SUMMARY
01/06/2023 First Asphalt Ticket
01/06/2023 Base Asphalt
01/06/2023 Letter INSPECTION SUMMARY
01/06/2023 Letter INSPECTION SUMMARY
01/11/2023 Sidewalk & ADA Ramp
01/11/2023 Letter INSPECTION SUMMARY
01/12/2023 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/16/2023 Saw Cut Removing Approach
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/17/2023 Ticket for Sidewalk, Curbs & Approach
01/17/2023 Forms and Materials for Sidewalk, Curbs & Approach
01/17/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/18/2023 Letter INSPECTION SUMMARY
01/20/2023 Letter INSPECTION SUMMARY
01/20/2023 Letter INSPECTION SUMMARY
01/20/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/02/2023 Curbs pavement drive-through
02/02/2023 Letter INSPECTION SUMMARY
02/03/2023 Letter INSPECTION SUMMARY
02/03/2023 Letter INSPECTION SUMMARY
02/04/2023 Mo Bettas curb demo #1
02/04/2023 No Bettas Curb Demo #2
02/04/2023 Mo Bettas Curb Demo #3
02/04/2023 Mo Bettas Stock Pile for Curb Pavement Demo #4
02/04/2023 Mo Bettas Curb Pavement Demo Replacement #5
02/04/2023 Mo Bettas Curb Pavement Demo Replacement #6
02/04/2023 Mo Bettas Sidewalk Demo for Light Pole #7
02/04/2023 Mo Bettas Curb Demo #8
02/04/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/08/2023 Letter INSPECTION SUMMARY
02/10/2023 Public Sidewalk ADA RampCurbs RedoCorrection #1
02/10/2023 Sidewalk ADA Ramp Curbs Eastside #2
02/10/2023 Letter INSPECTION SUMMARY
02/13/2023 Letter INSPECTION SUMMARY
02/13/2023 Letter INSPECTION SUMMARY
02/14/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/21/2023 Surface Pavement
02/21/2023 Pavement Ticket
02/21/2023 Letter INSPECTION SUMMARY
02/23/2023 Letter Fire Loss Reduction Form
02/27/2023 Letter INSPECTION SUMMARY
02/27/2023 Letter INSPECTION SUMMARY
02/28/2023 Letter INSPECTION SUMMARY
02/28/2023 Grading Grounds
02/28/2023 Letter INSPECTION SUMMARY
03/01/2023 Letter INSPECTION SUMMARY
03/02/2023 Receipt Receipt for transaction:2023-001192
03/02/2023 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/06/2023 Letter INSPECTION SUMMARY
03/06/2023 Letter INSPECTION SUMMARY
03/06/2023 Letter INSPECTION SUMMARY
03/07/2023 Letter Lees Summit FD
03/07/2023 3RD Party Insp Report Health
03/07/2023 Letter INSPECTION SUMMARY
03/07/2023 Letter 3_7 MB LS - FD Pass
03/07/2023 Letter Fire Loss Reduction Form
03/07/2023 Letter INSPECTION SUMMARY
03/07/2023 Letter Field Certificate of Occupancy
03/07/2023 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
