Summary


PRSUBD20190654
Public Infrastructure
Final Acceptance
JOHN KNOX VILLAGE
DEVELOPMENT COMPLETE
RESIDENTIAL SUBDIVISION INFRUSTRUCTURE - INCLUDES IMPROVEMENTS TO THE PRYOR RD AND OBRIEN RD INTERSECTION AND THE RECONSTRUCTION OF THE EXISTING DAM
03/22/2019
07/02/2019
12/16/2023
10/09/2023
Locations
Contacts
JOHN KNOX VILLAGE, Address:400 NW MURRAY RD
REDFORD CONSTRUCTION INC, Address:PO BOX 1065, Phone:(816) 540-2030
PREMIERLIFE REAL ESTATE HOLDINGS, Address:400 NW MURRAY RD
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/21/2019 06/20/2019
Mike Weisenborn
Woodside Ridge
Fees
Paid Fees Amount Paid Owing Date Paid
91100C9-Water Insp Fee $14,740.65 $14,740.65 Paid 06/14/2019
91100C8-Sanitary Sewer Insp Fees $26,835.25 $26,835.25 Paid 06/14/2019
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 06/14/2019
9110072-Water Test Fee $1,600.00 $1,600.00 Paid 06/14/2019
9110068-Storm Fee $18,064.89 $18,064.89 Paid 06/14/2019
9110081-Paved Surface Inspection Fee $38,344.13 $38,344.13 Paid 06/14/2019
$38,344.14
9110071-Site Grading Fee $35,246.15 $35,246.15 Paid 06/14/2019
9110071-Site Grading Fee $1,260.00 $1,260.00 Paid 03/02/2020
$36,506.13
Outstanding Fees Amount Paid Owing Date Paid


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary - Material Verification Passed 7/16/2019 07/17/2019
Misc
Informational
07/17/2019
8 inch sanitary pipe is SDR26 manufactured by North American Pipe Corporation. 4 inch service laterals are also SDR26. 8 inch ductile sanitary pipe is C50 manufactured by McWane Ductile. Manholes were manufactured by Barbour Concrete Company. The steps are model ML-13-NCR. Sewer lids are model 1502A. RP 7-16-19
Sanitary Sewer Construction Inspection Partial 7/25/2019 at 1:30 PM 07/26/2019
Misc
Informational
07/26/2019
The core drill has been made into MH 28-208, the boot was installed and appeared to be satisfactory. The installed approximately 2 sticks of pipe and then they installed the encasement for the crossing with ductile iron pipe. They put re-bar around the pipe on 6" instead of 12 that is required. They are hitting alot of rock so i do not expect them to get very far today.Steve Robbins 07/26/2019 8:43 AM
Sanitary Sewer Construction Inspection Partial 7/26/2019 at 11:30 AM 07/26/2019
Misc
Informational
07/26/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Sanitary Sewer Construction Inspection Partial 7/29/2019 at 11:00 AM 07/30/2019
Misc
Informational
07/26/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
07/30/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Sanitary Sewer Construction Inspection Partial 7/30/2019 08/02/2019
Misc
Informational
07/30/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
07/30/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/02/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Sanitary Sewer Construction Inspection Partial 8/5/2019 08/05/2019
Misc
Informational
08/02/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/02/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/02/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/05/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Sanitary Sewer Construction Inspection Partial 8/6/2019 08/06/2019
Misc
Informational
08/05/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/05/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/05/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/05/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/06/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Sanitary Sewer Construction Inspection Partial 8/7/2019 08/10/2019
Misc
Informational
08/06/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/06/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/06/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/06/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/06/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/08/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/10/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/10/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Sanitary Sewer Construction Inspection Partial 8/12/2019 08/14/2019
Misc
Informational
08/10/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/10/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/10/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/10/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/10/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/10/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/10/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/10/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/14/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Sanitary Sewer Construction Inspection Partial 8/14/2019 08/14/2019
Misc
Informational
08/14/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/14/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/14/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/14/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/14/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/14/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/14/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/14/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/14/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/14/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Sanitary Sewer Construction Inspection Partial 8/15/2019 08/21/2019
Misc
Informational
08/14/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/14/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/14/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/14/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/14/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/14/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/14/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/14/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/14/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/14/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
08/21/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Sanitary Sewer Construction Inspection Partial 8/22/2019 08/23/2019
Misc
Informational
08/21/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/21/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/21/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/21/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/21/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/21/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/21/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/21/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/21/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/21/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
08/21/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
08/22/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
08/23/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/23/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Erosion Control Inspection Failed 8/26/2019 08/26/2019
Misc
Corrective Action Required
08/26/2019
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Sanitary Sewer Construction Inspection Partial 8/26/2019 08/27/2019
Misc
Informational
08/23/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/23/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/23/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/23/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/23/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/23/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/23/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
08/23/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
08/23/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/23/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/23/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/23/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
08/23/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/23/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/27/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Erosion Control Inspection Failed 8/28/2019 08/28/2019
Misc
Corrective Action Required
08/26/2019
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
08/28/2019
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Sanitary Sewer Construction Inspection Partial 8/28/2019 08/28/2019
Misc
Informational
08/27/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/27/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/27/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/27/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/27/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
08/27/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
08/27/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/27/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/27/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/27/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
08/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/27/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
08/28/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Sanitary Sewer Construction Inspection Partial 9/16/2019 09/26/2019
Misc
Informational
08/28/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
08/28/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
08/28/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/28/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
08/28/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
08/28/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
08/28/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
08/28/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
08/28/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
08/28/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
08/28/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
08/28/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
08/28/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/28/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
08/28/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
08/28/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
09/26/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Sanitary Sewer Construction Inspection Partial 9/26/2019 09/27/2019
Misc
Informational
09/26/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
09/26/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
09/26/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
09/26/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
09/26/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
09/26/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
09/26/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
09/26/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
09/26/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
09/26/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
09/26/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
09/26/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
09/26/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
09/26/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
09/26/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
09/26/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
09/26/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
09/27/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Water Line - Abandonment Partial 9/30/2019 10/01/2019
Misc
Informational
10/01/2019
Redford severed the water line going to 500 Pryor. They capped it using mega lugs and poured a straddle block over the remaining section of active water line. They will return next week once the gas line has been removed to remove the remaining section of dead water line and fire hydrant. RP 10-1-19
Sanitary Sewer Construction Inspection Partial 9/30/2019 10/01/2019
Misc
Informational
09/27/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
09/27/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
09/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
09/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
09/27/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
09/27/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
09/27/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
09/27/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
09/27/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
09/27/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
09/27/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
09/27/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
09/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
09/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
09/27/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
09/27/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
09/27/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
09/27/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/01/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Sanitary Sewer Construction Inspection Partial 10/2/2019 10/18/2019
Misc
Informational
10/01/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
10/01/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
10/01/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/01/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/01/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
10/01/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
10/01/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
10/01/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
10/01/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
10/01/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
10/01/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
10/01/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
10/01/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/01/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/01/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
10/01/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
10/01/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
10/01/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/01/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
10/18/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Storm Sewer Construction Inspection Partial 9/18/2019 10/18/2019
Misc
Informational
10/18/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Sanitary Sewer Construction Inspection Partial 10/21/2019 10/22/2019
Misc
Informational
10/18/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
10/18/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
10/18/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/18/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/18/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
10/18/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
10/18/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
10/18/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
10/18/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
10/18/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
10/18/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
10/18/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
10/18/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/18/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/18/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
10/18/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
10/18/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
10/18/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/18/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
10/18/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
10/22/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Sanitary Sewer Construction Inspection Partial 10/23/2019 10/24/2019
Misc
Informational
10/22/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
10/22/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
10/22/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/22/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/22/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
10/22/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
10/22/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
10/22/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
10/22/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
10/22/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
10/22/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
10/22/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
10/22/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/22/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/22/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
10/22/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
10/22/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
10/22/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/22/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
10/22/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
10/22/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
10/24/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Storm Sewer Construction Inspection Partial 10/21/2019 10/24/2019
Misc
Informational
10/18/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
10/24/2019
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Sanitary Sewer Construction Inspection Partial 10/25/2019 10/25/2019
Misc
Informational
10/24/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/24/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
10/24/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
10/24/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
10/24/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
10/24/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/24/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
10/24/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
10/24/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
10/24/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
10/24/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
10/24/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
10/24/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/24/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/24/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
10/24/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
10/24/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
10/24/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/24/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
10/24/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
10/24/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
10/24/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
10/25/2019
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Storm Sewer Construction Inspection Partial 10/25/2019 10/25/2019
Misc
Informational
10/24/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
10/24/2019
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
10/25/2019
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Water Line - Construction Inspection Partial 10/24/2019 10/25/2019
Misc
Informational
10/25/2019
Darren’s crew laid road crossings for line 1 (Shamrock) and line 2 (Grady). Compaction test will be taken on Monday. RP 10-25-19
Sanitary Sewer Construction Inspection Partial 10/28/2019 11/08/2019
Misc
Informational
10/25/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/25/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
10/25/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
10/25/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
10/25/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
10/25/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
10/25/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
10/25/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
10/25/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
10/25/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
10/25/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
10/25/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
10/25/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/25/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
10/25/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
10/25/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
10/25/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
10/25/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
10/25/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
10/25/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
10/25/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
10/25/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
10/25/2019
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
11/01/2019
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
11/08/2019
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
11/08/2019
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
11/08/2019
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
11/08/2019
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
11/08/2019
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Storm Sewer Construction Inspection Partial 10/28/2019 11/27/2019
Misc
Informational
10/25/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
10/25/2019
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
10/25/2019
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
11/18/2019
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
11/27/2019
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
11/27/2019
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
11/27/2019
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
11/27/2019
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Sanitary Sewer Construction Inspection Partial 11/11/2019 11/27/2019
Misc
Informational
11/08/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
11/08/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
11/08/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
11/08/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
11/08/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
11/08/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
11/08/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
11/08/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
11/08/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
11/08/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
11/08/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
11/08/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
11/08/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
11/08/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
11/08/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
11/08/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
11/08/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
11/08/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
11/08/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
11/08/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
11/08/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
11/08/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
11/08/2019
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
11/08/2019
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
11/08/2019
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
11/08/2019
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
11/08/2019
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
11/08/2019
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
11/08/2019
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
11/18/2019
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
11/18/2019
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
11/18/2019
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
11/27/2019
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Sanitary Sewer - Vacuum Partial 11/4/2019 12/04/2019
Misc
Informational
12/04/2019
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Storm Sewer Construction Inspection Partial 12/2/2019 12/04/2019
Misc
Informational
11/27/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
11/27/2019
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
11/27/2019
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
11/27/2019
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
11/27/2019
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
11/27/2019
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
11/27/2019
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
11/27/2019
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
12/03/2019
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
12/04/2019
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
12/04/2019
Jim’s crew completed installation of storm line 9. RP 12-3-19
Sanitary Sewer Construction Inspection Partial 12/2/2019 12/27/2019
Misc
Informational
11/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
11/27/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
11/27/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
11/27/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
11/27/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
11/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
11/27/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
11/27/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
11/27/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
11/27/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
11/27/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
11/27/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
11/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
11/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
11/27/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
11/27/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
11/27/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
11/27/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
11/27/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
11/27/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
11/27/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
11/27/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
11/27/2019
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
11/27/2019
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
11/27/2019
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
11/27/2019
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
11/27/2019
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
11/27/2019
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
11/27/2019
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
11/27/2019
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
11/27/2019
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
11/27/2019
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
11/27/2019
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
12/03/2019
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
12/10/2019
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
12/27/2019
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
12/27/2019
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Sanitary Sewer - Mandrel Partial 11/13/2019 01/07/2020
Misc
Informational
01/07/2020
Mandrel passed through manholes 1-1 to 1-2, 1-2 to 1-3, 1-3 to 2-1 and 2-1 to 2-2. No mandrel test was required for existing manhole 28-208 to 1-1 and 1-4 to 1-5 because lines are ductile pipe. RP 1-7-20
Sanitary Sewer - Air Test Partial 11/4/2019 01/07/2020
Misc
Informational
01/07/2020
The following sanitary lines passed their air test: manhole existing 28-208 to 1-1, 1-1 to 1-2, 1-2 to 1-3, 1-3 to 1-4, and 1-4 to 1-5. RP 1-7-2020
Sanitary Sewer - Vacuum Partial 1/7/2020 01/07/2020
Misc
Informational
12/04/2019
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
01/07/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Storm Sewer Construction Inspection Partial 12/4/2019 01/29/2020
Misc
Informational
12/04/2019
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
12/04/2019
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
12/04/2019
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
12/04/2019
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
12/04/2019
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
12/04/2019
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
12/04/2019
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
12/04/2019
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
12/04/2019
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
12/04/2019
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
12/04/2019
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
12/10/2019
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
01/29/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Sanitary Sewer - Vacuum Partial 1/9/2020 02/07/2020
Misc
Informational
01/07/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
01/07/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
02/07/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Sanitary Sewer - Air Test Partial 1/9/2020 02/07/2020
Misc
Informational
01/07/2020
The following sanitary lines passed their air test: manhole existing 28-208 to 1-1, 1-1 to 1-2, 1-2 to 1-3, 1-3 to 1-4, and 1-4 to 1-5. RP 1-7-2020
Misc
Informational
02/07/2020
The following sanitary lines passed their air test. Manholes 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 2-7-20
Storm Sewer Construction Inspection Partial 1/29/2020 02/11/2020
Misc
Informational
01/29/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
01/29/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
01/29/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
01/29/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
01/29/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
01/29/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
01/29/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
01/29/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
01/29/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
01/29/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
01/29/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
01/29/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
01/29/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
02/11/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Sanitary Sewer Construction Inspection Partial 12/31/2019 02/11/2020
Misc
Informational
12/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
12/27/2019
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
12/27/2019
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
12/27/2019
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
12/27/2019
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
12/27/2019
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
12/27/2019
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
12/27/2019
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
12/27/2019
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
12/27/2019
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
12/27/2019
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
12/27/2019
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
12/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
12/27/2019
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
12/27/2019
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
12/27/2019
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
12/27/2019
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
12/27/2019
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
12/27/2019
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
12/27/2019
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
12/27/2019
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
12/27/2019
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
12/27/2019
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
12/27/2019
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
12/27/2019
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
12/27/2019
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
12/27/2019
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
12/27/2019
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
12/27/2019
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
12/27/2019
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
12/27/2019
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
12/27/2019
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
12/27/2019
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
12/27/2019
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
12/27/2019
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
12/27/2019
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
12/27/2019
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Misc
Informational
02/11/2020
Darren’s crew has been working on sanitary line 10. They have cored into existing manhole 28-100, along with setting manholes 10-1, 10-2 and 10-3. Jim’s crew is working on sanitary line 9. They have bored into existing manhole 28-099 and they have set manholes 9-1 and 9-2. RP 2-11-20
Water Line - Construction Inspection Partial 10/28/2019 02/11/2020
Misc
Informational
02/11/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Sanitary Sewer Construction Inspection Partial 2/14/2020 02/19/2020
Misc
Informational
02/11/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/11/2020
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
02/11/2020
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
02/11/2020
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
02/11/2020
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
02/11/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/11/2020
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
02/11/2020
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
02/11/2020
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
02/11/2020
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
02/11/2020
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
02/11/2020
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
02/11/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/11/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/11/2020
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
02/11/2020
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
02/11/2020
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
02/11/2020
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
02/11/2020
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
02/11/2020
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
02/11/2020
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
02/11/2020
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
02/11/2020
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
02/11/2020
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
02/11/2020
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
02/11/2020
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
02/11/2020
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
02/11/2020
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
02/11/2020
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
02/11/2020
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
02/11/2020
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
02/11/2020
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
02/11/2020
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
02/11/2020
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
02/11/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/11/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/11/2020
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Misc
Informational
02/11/2020
Darren’s crew has been working on sanitary line 10. They have cored into existing manhole 28-100, along with setting manholes 10-1, 10-2 and 10-3. Jim’s crew is working on sanitary line 9. They have bored into existing manhole 28-099 and they have set manholes 9-1 and 9-2. RP 2-11-20
Misc
Informational
02/19/2020
Darren’s crew set manhole 10-4 along with service laterals. Jim’s crew set manholes 9-3 and 9-4. 9-3 drop is supported with rebar. They will pour the inverts and encase the drop with concrete tomorrow. RP 2-19-20
Sanitary Sewer Construction Inspection Partial 2/20/2020 02/27/2020
Misc
Informational
02/19/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/19/2020
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
02/19/2020
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
02/19/2020
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
02/19/2020
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
02/19/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/19/2020
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
02/19/2020
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
02/19/2020
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
02/19/2020
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
02/19/2020
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
02/19/2020
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
02/19/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/19/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/19/2020
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
02/19/2020
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
02/19/2020
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
02/19/2020
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
02/19/2020
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
02/19/2020
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
02/19/2020
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
02/19/2020
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
02/19/2020
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
02/19/2020
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
02/19/2020
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
02/19/2020
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
02/19/2020
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
02/19/2020
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
02/19/2020
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
02/19/2020
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
02/19/2020
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
02/19/2020
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
02/19/2020
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
02/19/2020
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
02/19/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/19/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/19/2020
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Misc
Informational
02/19/2020
Darren’s crew has been working on sanitary line 10. They have cored into existing manhole 28-100, along with setting manholes 10-1, 10-2 and 10-3. Jim’s crew is working on sanitary line 9. They have bored into existing manhole 28-099 and they have set manholes 9-1 and 9-2. RP 2-11-20
Misc
Informational
02/19/2020
Darren’s crew set manhole 10-4 along with service laterals. Jim’s crew set manholes 9-3 and 9-4. 9-3 drop is supported with rebar. They will pour the inverts and encase the drop with concrete tomorrow. RP 2-19-20
Misc
Informational
02/27/2020
Darren’s crew set manhole 10-5 which completed sanitary line 10. Jim’s crew set manholes 9-5 and 9-6. RP 2-27-20
Water Line - Abandonment Partial 10/8/2019 02/27/2020
Misc
Informational
02/27/2020
Darren’s crew removed the old fire hydrant, service line and meter well that went to the vacant office off Pryor. I contacted Brad Woodford at Water about the meter well lid and fire hydrant. He said they would be out on Friday to reclaim the materials. RP 2-27-20
Water Line - Hydrostatic Test Partial 2/28/2020 02/28/2020
Misc
Informational
02/28/2020
The water line off of Shamrock (south end of Woodside Ridge) held pressure over 150 PSI for 2 hrs. RP 2-28-20
Water Line - Coliform Test 1 Partial 2/28/2020 02/28/2020
Misc
Informational
02/28/2020
Chlorinated the water line for Shamrock and Joshua. We will dechlorinate the lines tomorrow at 1PM. RP 2-28-20
Water Line - Coliform Test 1 Partial 2/29/2020 02/29/2020
Misc
Informational
02/28/2020
Chlorinated the water line for Shamrock and Joshua. We will dechlorinate the lines tomorrow at 1PM. RP 2-28-20
Misc
Informational
02/29/2020
Dechlorinated the water line off Shamrock and Joshua. We will pull first Bac T samples on Monday. RP 2-29-20
Water Line - Coliform Test 1 Partial 3/2/2020 03/02/2020
Misc
Informational
02/29/2020
Chlorinated the water line for Shamrock and Joshua. We will dechlorinate the lines tomorrow at 1PM. RP 2-28-20
Misc
Informational
02/29/2020
Dechlorinated the water line off Shamrock and Joshua. We will pull first Bac T samples on Monday. RP 2-29-20
Misc
Informational
03/02/2020
Collected first Bac T samples at 3 locations with John from Redford Construction. Will get the results from Keystone Laboratories tomorrow. RP 3-2-20
Water Line - Coliform Test 2 Partial 3/3/2020 03/03/2020
Misc
Informational
03/03/2020
Collected second Bac T samples from Shamrock and Joshua. Delivered samples to Keystone Laboratories for testing. Still waiting to hear back on first Bac T samples. RP 3-3-20
Sanitary Sewer Construction Inspection Partial 2/28/2020 03/03/2020
Misc
Informational
02/27/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/27/2020
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
02/27/2020
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
02/27/2020
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
02/27/2020
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
02/27/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
02/27/2020
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
02/27/2020
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
02/27/2020
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
02/27/2020
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
02/27/2020
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
02/27/2020
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
02/27/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/27/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
02/27/2020
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
02/27/2020
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
02/27/2020
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
02/27/2020
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
02/27/2020
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
02/27/2020
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
02/27/2020
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
02/27/2020
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
02/27/2020
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
02/27/2020
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
02/27/2020
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
02/27/2020
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
02/27/2020
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
02/27/2020
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
02/27/2020
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
02/27/2020
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
02/27/2020
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
02/27/2020
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
02/27/2020
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
02/27/2020
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
02/27/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/27/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
02/27/2020
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Misc
Informational
02/27/2020
Darren’s crew has been working on sanitary line 10. They have cored into existing manhole 28-100, along with setting manholes 10-1, 10-2 and 10-3. Jim’s crew is working on sanitary line 9. They have bored into existing manhole 28-099 and they have set manholes 9-1 and 9-2. RP 2-11-20
Misc
Informational
02/27/2020
Darren’s crew set manhole 10-4 along with service laterals. Jim’s crew set manholes 9-3 and 9-4. 9-3 drop is supported with rebar. They will pour the inverts and encase the drop with concrete tomorrow. RP 2-19-20
Misc
Informational
02/27/2020
Darren’s crew set manhole 10-5 which completed sanitary line 10. Jim’s crew set manholes 9-5 and 9-6. RP 2-27-20
Misc
Informational
03/02/2020
Jim’s crew set manhole 9-7. Darren’s crew is laying sanitary pipe out of manhole 11-4. RP 3-2-20
Misc
Informational
03/03/2020
Darren’s crew set manhole 11-5, which completed sanitary line 11. All they have remaining is sanitary line 13 to install. Jim’s crew set manhole 9-8. They are now going back to install the service laterals for lots 72, 71, 70 and 69. RP 3-3-20
Water Line - Coliform Test 1 Passed 3/3/2020 03/06/2020
Misc
Informational
03/02/2020
Chlorinated the water line for Shamrock and Joshua. We will dechlorinate the lines tomorrow at 1PM. RP 2-28-20
Misc
Informational
03/02/2020
Dechlorinated the water line off Shamrock and Joshua. We will pull first Bac T samples on Monday. RP 2-29-20
Misc
Informational
03/02/2020
Collected first Bac T samples at 3 locations with John from Redford Construction. Will get the results from Keystone Laboratories tomorrow. RP 3-2-20
Misc
Informational
03/06/2020
First Bac T samples passed. RP 3-4-20
Water Line - Coliform Test 2 Passed 3/5/2020 03/06/2020
Misc
Informational
03/03/2020
Collected second Bac T samples from Shamrock and Joshua. Delivered samples to Keystone Laboratories for testing. Still waiting to hear back on first Bac T samples. RP 3-3-20
Misc
Informational
03/06/2020
Second Bac T samples for Shamrock and Joshua passed. RP 3-5-20
Sanitary Sewer - Air Test Partial 2/10/2020 03/06/2020
Misc
Informational
02/07/2020
The following sanitary lines passed their air test: manhole existing 28-208 to 1-1, 1-1 to 1-2, 1-2 to 1-3, 1-3 to 1-4, and 1-4 to 1-5. RP 1-7-2020
Misc
Informational
02/07/2020
The following sanitary lines passed their air test. Manholes 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 2-7-20
Misc
Informational
03/05/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Corrective Action Required
03/06/2020
The following sanitary line failed the air test: 8-1 to 8-2. Jim Weers thinks he knows what could have caused the failed test. We will retest the line again in the future. RP 3-6-20
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: 8-0 to 8-1, 8-2 to 8-3, 8-3 to 8-4, 8-4 to 8-5, 8-5 to 8-6 and 8-6 to 8-7. RP 3-6-20
Sanitary Sewer - Vacuum Partial 2/10/2020 03/06/2020
Misc
Informational
02/07/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
02/07/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
02/07/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
03/05/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Sanitary Sewer - Mandrel Partial 1/9/2020 03/06/2020
Misc
Informational
01/07/2020
Mandrel passed through manholes 1-1 to 1-2, 1-2 to 1-3, 1-3 to 2-1 and 2-1 to 2-2. No mandrel test was required for existing manhole 28-208 to 1-1 and 1-4 to 1-5 because lines are ductile pipe. RP 1-7-20
Misc
Informational
03/05/2020
The following sanitary lines passed the mandrel test : 1-3 to 1-4, 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed the mandrel test : 1-3 to 1-4, 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed their mandrel test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13, 1-10 to 4-1, 8-0 to 8-1, 8-1 to 8-2, 8-2 to 8-3, 8-3 to 8-4, 8-4 to 8-5, 8-5 to 8-6 and 8-6 to 8-7. RP 3-6-20
Storm Sewer Construction Inspection Partial 2/17/2020 03/06/2020
Misc
Informational
02/11/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
02/11/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
02/11/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
02/11/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
02/11/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
02/11/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
02/11/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
02/11/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
02/11/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
02/11/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
02/11/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
02/11/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
02/11/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
02/11/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Misc
Informational
03/03/2020
Darren’s crew has started working on storm line 14 between end section 14-0 and manhole 14-1. RP 3-3-20
Misc
Informational
03/06/2020
Darren’s crew set curb inlet 14-2. RP 3-5-20
Water Line - Construction Inspection Partial 2/26/2020 03/31/2020
Misc
Informational
02/11/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
03/26/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
03/31/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
03/31/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
03/31/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Storm Sewer Construction Inspection Partial 3/9/2020 03/31/2020
Misc
Informational
03/06/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
03/06/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
03/06/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
03/06/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
03/06/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
03/06/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
03/06/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
03/06/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
03/06/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
03/06/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
03/06/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
03/06/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
03/06/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
03/06/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Misc
Informational
03/06/2020
Darren’s crew has started working on storm line 14 between end section 14-0 and manhole 14-1. RP 3-3-20
Misc
Informational
03/06/2020
Darren’s crew set storm manhole 14-2. RP 3-5-20
Misc
Informational
03/31/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
03/31/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
03/31/2020
Darren’s crew completed storm section from 14-2 to 14-3. They also set curb inlet 14-3. RP 3-31-20
Storm Sewer Construction Inspection Partial 4/1/2020 04/03/2020
Misc
Informational
03/31/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
03/31/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
03/31/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
03/31/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
03/31/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
03/31/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
03/31/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
03/31/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
03/31/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
03/31/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
03/31/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
03/31/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
03/31/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
03/31/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Misc
Informational
03/31/2020
Darren’s crew has started working on storm line 14 between end section 14-0 and manhole 14-1. RP 3-3-20
Misc
Informational
03/31/2020
Darren’s crew set storm manhole 14-2. RP 3-5-20
Misc
Informational
03/31/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
03/31/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
03/31/2020
Darren’s crew completed storm section from 14-2 to 14-3. They also set curb inlet 14-3. RP 3-31-20
Misc
Informational
04/03/2020
Darren’s crew set manhole 14-4 and field inlet 14-5. That completes storm line 14. RP 4-2-20
Water Line - Construction Inspection Partial 4/1/2020 04/03/2020
Misc
Informational
03/31/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
03/31/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
03/31/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
03/31/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
03/31/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
04/03/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Storm Sewer Construction Inspection Partial 4/6/2020 04/09/2020
Misc
Informational
04/03/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
04/03/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
04/03/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
04/03/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
04/03/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
04/03/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
04/03/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
04/03/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
04/03/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
04/03/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
04/03/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
04/03/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
04/03/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
04/03/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Misc
Informational
04/03/2020
Darren’s crew has started working on storm line 14 between end section 14-0 and manhole 14-1. RP 3-3-20
Misc
Informational
04/03/2020
Darren’s crew set storm manhole 14-2. RP 3-5-20
Misc
Informational
04/03/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
04/03/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
04/03/2020
Darren’s crew completed storm section from 14-2 to 14-3. They also set curb inlet 14-3. RP 3-31-20
Misc
Informational
04/03/2020
Darren’s crew set manhole 14-4 and field inlet 14-5. That completes storm line 14. RP 4-2-20
Misc
Informational
04/09/2020
Darren’s crew has set end of storm 13-0, manhole 13-1 and curb inlet 13-2. RP 4-9-20
Water Line - Construction Inspection Partial 4/6/2020 04/09/2020
Misc
Informational
04/03/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
04/03/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
04/03/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/03/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/03/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
04/03/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
04/09/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Water Line - Abandonment Passed 4/9/2020 04/14/2020
Misc
Informational
04/14/2020
Jimmy’s crew removed the old water main, both water services and fire hydrant along O’Brien. RP 4-9-20
Storm Sewer Construction Inspection Partial 4/13/2020 04/14/2020
Misc
Informational
04/09/2020
Jim’s crew has completed storm lines 1 and 16. They are working on storm line 2. Curb inlet box 2-5 was manufactured wrong and has to be replaced. They also set storm lines A and B. Field inlet B-0 is setting high compared to neighboring yard. They need to reshoot elevations and see what is wrong and how to correct the issue. RP 10-18-19
Misc
Informational
04/09/2020
Darren’s crew reset the corrected curb inlet 2-5 and curb inlet 2-6. They also set 60 ft of storm pipe. RP 10-24-19
Misc
Informational
04/09/2020
Darren’s crew set curb inlet 17-1 and laid 150 ft of storm pipe. They also poured collars and inverts for curb inlets 2-5, 2-6 and 17-1. RP 10-25-19
Misc
Informational
04/09/2020
Jim’s crew installed storm line 10. This included manhole 10-1, curb inlets 10-2 and 10-3, along with 264 ft of 24 inch corrugated HDPE storm pipe. RP 11-18-19
Misc
Informational
04/09/2020
Jim’s crew set storm manhole 6-1 and curb inlet 6-2 along with 130 ft of 24 inch HPDE storm pipe. RP 11-21-19
Misc
Informational
04/09/2020
Jim’s crew set storm outlet 6-0 and curb inlet 6-3 along with 110 ft of 30 inch and 40 ft of 24 inch HDPE storm pipe. RP 11-25-19
Misc
Informational
04/09/2020
Jim’s crew set field inlet 6-4 along with 160 ft of 18 inch HDPE storm pipe. RP11-26-19
Misc
Informational
04/09/2020
Jim’s crew encountered a rock shelf on storm line 6 that they have to break out. The set 110 ft of 15 inch HDPE storm pipe. RP 11-27-19
Misc
Informational
04/09/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
04/09/2020
Jim’s crew completed storm line 6 and is moving on to storm lines 8 and 9. RP 12-3-19
Misc
Informational
04/09/2020
Jim’s crew completed installation of storm line 9. RP 12-3-19
Misc
Informational
04/09/2020
Jim’s crew completed storm lines 7 and 8. They also laid 600 ft of 15 inch HDPE storm pipe. RP 12-6-12
Misc
Informational
04/09/2020
Jim’s crew has completed storm line 4. They have also set MH 4-1 and curb inlets 4-2 and 4-3. RP 1-28-20
Misc
Informational
04/09/2020
Jim’s crew completed storm line 3. They set curb inlets 3-3, 3-4, 3-5 and 3-6. RP 2-7-20
Misc
Informational
04/09/2020
Darren’s crew has started working on storm line 14 between end section 14-0 and manhole 14-1. RP 3-3-20
Misc
Informational
04/09/2020
Darren’s crew set storm manhole 14-2. RP 3-5-20
Misc
Informational
04/09/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
04/09/2020
Darren’s crew finished storm line 15 and set manhole 15-1 and curb inlets 15-2 and 15-3. RP 3-30-20
Misc
Informational
04/09/2020
Darren’s crew completed storm section from 14-2 to 14-3. They also set curb inlet 14-3. RP 3-31-20
Misc
Informational
04/09/2020
Darren’s crew set manhole 14-4 and field inlet 14-5. That completes storm line 14. RP 4-2-20
Misc
Informational
04/09/2020
Darren’s crew has set end of storm 13-0, manhole 13-1 and curb inlet 13-2. RP 4-9-20
Misc
Informational
04/14/2020
Darren’s crew set curb inlets 13-3 and 13-4. That completes storm line 13. RP 4-13-20
Miscellaneous PWORKS Inspection Partial 4/15/2020 04/16/2020
PW-Misc
Informational
04/16/2020
Capital Electric poured the signal base. They didn’t have a third party tester on site. I let them use the test results from the pour at Street of West Pryor. RP 4-15-20
Sanitary Sewer - Air Test Partial 4/14/2020 04/16/2020
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: manhole existing 28-208 to 1-1, 1-1 to 1-2, 1-2 to 1-3, 1-3 to 1-4, and 1-4 to 1-5. RP 1-7-2020
Misc
Informational
03/06/2020
The following sanitary lines passed their air test. Manholes 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 2-7-20
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Corrective Action Required
03/06/2020
The following sanitary line failed the air test: 8-1 to 8-2. Jim Weers thinks he knows what could have caused the failed test. We will retest the line again in the future. RP 3-6-20
Misc
Informational
03/06/2020
The following sanitary lines passed their air test: 8-0 to 8-1, 8-2 to 8-3, 8-3 to 8-4, 8-4 to 8-5, 8-5 to 8-6 and 8-6 to 8-7. RP 3-6-20
Misc
Informational
04/15/2020
The following sanitary lines passed their air test: 11-5 to 11-4, 11-4 to 11-3, 11-3 to 11-2, 11-2 to 11-1 and 11-1 to existing MH 28-103. RP 4-14-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: Existing manhole 28-100 to 10-1, 10-1 to 10-2, 10-2 to 10-3, 10-3 to 10-4, 10-4 to 10-5, 11-3 to 12-1, 12-1 to 12-2, 12-2 to 12-3, 12-3 to 12-4, 12-4 to 12-5 and 12-1 to 13-1. RP 4-16-20
Sanitary Sewer - Vacuum Partial 4/14/2020 04/16/2020
Misc
Informational
03/06/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
03/06/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
03/06/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
03/06/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
03/06/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Misc
Informational
04/15/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/16/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/16/2020
Manhole 10-1 passed it’s vacuum test. The following manholes passed their vacuum test but needs to be retested once they are back filled to grade: 10-2, 10-3, 10-4, 10-5, 12-1, 12-2, 12-3, 12-4 and12-5. Manhole 11-3 passed its retest, but needs to be retested once it is back filled to grade. Manhole 11-2 FAILED again and needs to retested once it’s repaired. RP 4-16-20
Sanitary Sewer - Mandrel Passed 4/14/2020 04/23/2020
Misc
Informational
03/06/2020
Mandrel passed through manholes 1-1 to 1-2, 1-2 to 1-3, 1-3 to 2-1 and 2-1 to 2-2. No mandrel test was required for existing manhole 28-208 to 1-1 and 1-4 to 1-5 because lines are ductile pipe. RP 1-7-20
Misc
Informational
03/06/2020
The following sanitary lines passed the mandrel test : 1-3 to 1-4, 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed the mandrel test : 1-3 to 1-4, 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 3-5-20
Misc
Informational
03/06/2020
The following sanitary lines passed their mandrel test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13, 1-10 to 4-1, 8-0 to 8-1, 8-1 to 8-2, 8-2 to 8-3, 8-3 to 8-4, 8-4 to 8-5, 8-5 to 8-6 and 8-6 to 8-7. RP 3-6-20
Misc
Informational
04/23/2020
All sanitary lines have passed their mandrel test. RP 4-20-20
Sanitary Sewer - Air Test Passed 4/21/2020 04/23/2020
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: manhole existing 28-208 to 1-1, 1-1 to 1-2, 1-2 to 1-3, 1-3 to 1-4, and 1-4 to 1-5. RP 1-7-2020
Misc
Informational
04/16/2020
The following sanitary lines passed their air test. Manholes 1-5 to 1-6, 1-6 to 1-7, 1-7 to 3-1 and 3-1 to 3-2. RP 2-7-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: 1-7 to 1-8, 1-8 to 1-9, 1-9 to 1-10, 1-10 to 1-11, 1-11 to 1-12, 1-12 to 1-13 and 1-10 to 4-1. RP 3-5-20
Misc
Corrective Action Required
04/16/2020
The following sanitary line failed the air test: 8-1 to 8-2. Jim Weers thinks he knows what could have caused the failed test. We will retest the line again in the future. RP 3-6-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: 8-0 to 8-1, 8-2 to 8-3, 8-3 to 8-4, 8-4 to 8-5, 8-5 to 8-6 and 8-6 to 8-7. RP 3-6-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: 11-5 to 11-4, 11-4 to 11-3, 11-3 to 11-2, 11-2 to 11-1 and 11-1 to existing MH 28-103. RP 4-14-20
Misc
Informational
04/16/2020
The following sanitary lines passed their air test: Existing manhole 28-100 to 10-1, 10-1 to 10-2, 10-2 to 10-3, 10-3 to 10-4, 10-4 to 10-5, 11-3 to 12-1, 12-1 to 12-2, 12-2 to 12-3, 12-3 to 12-4, 12-4 to 12-5 and 12-1 to 13-1. RP 4-16-20
Misc
Informational
04/23/2020
All sanitary lines have passed their air test. RP 4-20-20
Sanitary Sewer - Vacuum Partial 4/21/2020 04/23/2020
Misc
Informational
04/16/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
04/16/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
04/16/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
04/16/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
04/16/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
04/16/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Misc
Informational
04/16/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/16/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/16/2020
Manhole 10-1 passed it’s vacuum test. The following manholes passed their vacuum test but needs to be retested once they are back filled to grade: 10-2, 10-3, 10-4, 10-5, 12-1, 12-2, 12-3, 12-4 and12-5. Manhole 11-3 passed its retest, but needs to be retested once it is back filled to grade. Manhole 11-2 FAILED again and needs to retested once it’s repaired. RP 4-16-20
Misc
Informational
04/23/2020
Currently all sanitary manholes have passed their vacuum test. Will have to retest manholes on sanitary lines 10, 11, 12 and 13 once the area has been back filled to the proper grade. RP 4-22-20
Water Line - Construction Inspection Partial 4/13/2020 04/23/2020
Misc
Informational
04/09/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
04/09/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
04/09/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/09/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/09/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
04/09/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
04/09/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
04/15/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
04/23/2020
Line 4 has been completely installed. RP 4-21-20
Water Line - Hydrostatic Test Partial 4/23/2020 04/23/2020
Misc
Informational
02/28/2020
The water line off of Shamrock (south end of Woodside Ridge) held pressure over 150 PSI for 2 hrs. RP 2-28-20
Misc
Informational
04/23/2020
Water lines 4, 5, 6, 7, 8 and 9 held 150 PSI for 2 hours. RP 4-23-20
Water Line - Coliform Test 1 Partial 4/23/2020 04/23/2020
Misc
Informational
04/23/2020
Water lines 4, 5, 6, 7, 8 and 9 have been chlorinated. We will start dechlorinating tomorrow at 1:30 PM. RP 4-23-20
Miscellaneous PWORKS Inspection Partial 4/23/2020 04/23/2020
PW-Misc
Informational
04/16/2020
Capital Electric poured the signal base. They didn’t have a third party tester on site. I let them use the test results from the pour at Street of West Pryor. RP 4-15-20
Misc
Informational
04/23/2020
Capital Electric mover the signal pole on the west side of O’Brien. Signal is back up and operational. Scott Koch from Public Works has been out to inspect the signal. RP 4-23-20
PW-Misc
Informational
04/23/2020
Capital Electric mover the signal pole on the west side of O’Brien. Signal is back up and operational. Scott Koch from Public Works has been out to inspect the signal. RP 4-23-20
Water Line - Coliform Test 1 Partial 4/24/2020 04/24/2020
Misc
Informational
04/23/2020
Water lines 4, 5, 6, 7, 8 and 9 have been chlorinated. We will start dechlorinating tomorrow at 1:30 PM. RP 4-23-20
Misc
Informational
04/24/2020
We dechlorniated the water lines today. We will pull the first Bac T samples on Monday morning. RP 4-24-20
Water Line - Coliform Test 1 Partial 4/27/2020 04/27/2020
Misc
Informational
04/24/2020
Water lines 4, 5, 6, 7, 8 and 9 have been chlorinated. We will start dechlorinating tomorrow at 1:30 PM. RP 4-23-20
Misc
Informational
04/24/2020
We dechlorniated the water lines today. We will pull the first Bac T samples on Monday morning. RP 4-24-20
Misc
Informational
04/27/2020
Pull 5 water samples for Bac T testing with Daniel. Dropped the samples off at Keystone Laboratories for testing. Will get the results back tomorrow. RP 4-27-20
Water Line - Coliform Test 1 Passed 4/28/2020 04/29/2020
Misc
Informational
04/27/2020
Water lines 4, 5, 6, 7, 8 and 9 have been chlorinated. We will start dechlorinating tomorrow at 1:30 PM. RP 4-23-20
Misc
Informational
04/27/2020
We dechlorniated the water lines today. We will pull the first Bac T samples on Monday morning. RP 4-24-20
Misc
Informational
04/27/2020
Pull 5 water samples for Bac T testing with Daniel. Dropped the samples off at Keystone Laboratories for testing. Will get the results back tomorrow. RP 4-27-20
Misc
Informational
04/29/2020
Samples passed their first Bac T test. RP 4-29-20
Water Line - Coliform Test 2 Failed 4/28/2020 04/30/2020
Misc
Informational
04/29/2020
Pulled second samples for Bac T testing. RP 4-28-20
Misc
Informational
04/30/2020
The dead end section of line 9 failed the second test. The rest of the lines passed. We will be retesting line 9. RP 4-30-20
Water Line - Coliform Test 1 Partial 4/30/2020 04/30/2020
Misc
Informational
04/30/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Water Line - Coliform Test 2 Partial 5/1/2020 05/01/2020
Misc
Informational
04/30/2020
Pulled second samples for Bac T testing. RP 4-28-20
Misc
Informational
04/30/2020
The dead end section of line 9 failed the second test. The rest of the lines passed. We will be retesting line 9. RP 4-30-20
Misc
Informational
05/01/2020
Pulled second sample from dead end section of line 9. Delivered sample to Keystone Laboratories. Still waiting to hear if the first sample has passed yet. RP 5-1-20
Water Line - Coliform Test 1 Partial 5/1/2020 05/04/2020
Misc
Informational
04/30/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Misc
Informational
05/04/2020
First retest of dead end section of line 9 passed it’s Bac T test. RP 5-4-20
Water Line - Coliform Test 2 Partial 5/2/2020 05/04/2020
Misc
Informational
05/01/2020
Pulled second samples for Bac T testing. RP 4-28-20
Misc
Informational
05/01/2020
The dead end section of line 9 failed the second test. The rest of the lines passed. We will be retesting line 9. RP 4-30-20
Misc
Informational
05/01/2020
Pulled second sample from dead end section of line 9. Delivered sample to Keystone Laboratories. Still waiting to hear if the first sample has passed yet. RP 5-1-20
Misc
Informational
05/04/2020
Dead end section of line 9 passed its second Bac T test. RP 5-4-20
Water Line - Construction Inspection Partial 5/6/2020 05/06/2020
Misc
Informational
04/23/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
04/23/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
04/23/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/23/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
04/23/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
04/23/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
04/23/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
04/23/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
04/23/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
05/06/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Miscellaneous PWORKS Inspection Passed 5/7/2020 05/08/2020
PW-Misc
Informational
04/23/2020
Capital Electric poured the signal base. They didn’t have a third party tester on site. I let them use the test results from the pour at Street of West Pryor. RP 4-15-20
Misc
Informational
04/23/2020
Capital Electric mover the signal pole on the west side of O’Brien. Signal is back up and operational. Scott Koch from Public Works has been out to inspect the signal. RP 4-23-20
PW-Misc
Informational
04/23/2020
Capital Electric mover the signal pole on the west side of O’Brien. Signal is back up and operational. Scott Koch from Public Works has been out to inspect the signal. RP 4-23-20
Misc
Informational
05/08/2020
Kevin’s crew installed the last pedestrian crossing signal at Pryor and O’Brien. RP 5-8-20
Erosion Control Inspection Failed 3/7/2020 05/28/2020
Misc
Corrective Action Required
08/28/2019
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
08/28/2019
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
05/28/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Erosion Control Inspection Partial 5/29/2020 5/29/2020 05/29/2020
Misc
Corrective Action Required
05/28/2020
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
05/28/2020
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
05/28/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Misc
Informational
05/29/2020
Silt has been swept up from the roadways. Welch Erosion still needs to repair erosion control devices. RP 5-29-20
Erosion Control Inspection Failed 6/2/2020 6/2/2020 06/02/2020
Misc
Corrective Action Required
05/29/2020
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
05/29/2020
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
05/29/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Misc
Informational
05/29/2020
Silt has been swept up from the roadways. Welch Erosion still needs to repair erosion control devices. RP 5-29-20
Misc
Corrective Action Required
06/02/2020
SWWWP report from Welch Erosion had nothing listed for the erosion issues off of Ambersham last Thursday. RP 6-2-20
Pavement-Stabilized Subgrade Partial 6/3/2020 6/3/2020 06/03/2020
Misc
Informational
06/03/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Erosion Control Inspection Partial 6/4/2020 6/4/2020 06/04/2020
Misc
Corrective Action Required
06/02/2020
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
06/02/2020
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
06/02/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Misc
Informational
06/02/2020
Silt has been swept up from the roadways. Welch Erosion still needs to repair erosion control devices. RP 5-29-20
Misc
Corrective Action Required
06/02/2020
SWWWP report from Welch Erosion had nothing listed for the erosion issues off of Ambersham last Thursday. RP 6-2-20
Misc
Informational
06/04/2020
No work is being done today due to last nights storm. No erosion issues and the fence that was down on Ambersham has been repaired. RP 6-4-20
Site Visit Partial 6/8/2020 6/8/2020 06/08/2020
Misc
Informational
06/08/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Pavement-Proof Roll Partial 6/10/2020 6/10/2020 06/10/2020
Misc
Corrective Action Required
06/10/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Pavement-Stabilized Subgrade Partial 6/11/2020 6/11/2020 06/11/2020
Misc
Informational
06/03/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
06/11/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Pavement-Stabilized Subgrade Partial 6/12/2020 6/12/2020 06/12/2020
Misc
Informational
06/11/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
06/11/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
06/12/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Pavement-Proof Roll Partial 6/16/2020 6/16/2020 06/16/2020
Misc
Corrective Action Required
06/10/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
06/16/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Storm - Pipe Partial 6/15/2020 6/15/2020 06/16/2020
Misc
Informational
06/16/2020
Redford cut into the roadway and set under drains across Joshua and Grady. RP 6-15-20
Site Visit Partial 6/9/2020 6/9/2020 06/17/2020
Misc
Informational
06/08/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
06/17/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Pavement-Curb Construction Partial 6/18/2020 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Pavement-Curb Construction Partial 6/19/2020 6/19/2020 06/19/2020
Misc
Informational
06/18/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
06/19/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Pavement-Curb Construction Partial 6/22/2020 6/22/2020 06/22/2020
Misc
Informational
06/19/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
06/19/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
06/22/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
ADA Inspection Partial 6/24/2020 6/24/2020 06/24/2020
Misc
Informational
06/24/2020
Forms were placed and aggregate was present and compacted. RP 6-24-20
Pavement-Stabilized Subgrade Partial 6/24/2020 6/24/2020 06/24/2020
Misc
Informational
06/12/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
06/12/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
06/12/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
06/24/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Pavement-Curb Construction Partial 6/23/2020 6/23/2020 06/25/2020
Misc
Informational
06/22/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
06/22/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
06/22/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
06/25/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Sidewalk Inspection Partial 6/25/2020 6/25/2020 06/25/2020
Misc
Informational
06/25/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Pavement-Proof Roll Partial 6/26/2020 6/26/2020 06/26/2020
Misc
Corrective Action Required
06/16/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
06/16/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
06/26/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Pavement-Surface Partial 6/29/2020 6/29/2020 06/29/2020
Misc
Informational
06/29/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Pavement-Proof Roll Failed 6/30/2020 6/30/2020 06/30/2020
Misc
Corrective Action Required
06/26/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
06/26/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
06/26/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Misc
Corrective Action Required
06/30/2020
Spalding had a tandem dump truck with a 20.1 ton load. Proof rolled the center section (O'Brien, Killarney and Ambersham). Most of the sub-grade passed, but we had numerous areas with little or extreme pumping. Brian is going to dig out the problem areas and add additional rock to those areas. RP 6-30-20
Pavement-Stabilized Subgrade Partial 6/30/2020 6/30/2020 06/30/2020
Misc
Informational
06/24/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
06/24/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
06/24/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
06/24/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
06/30/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Sidewalk Inspection Partial 7/2/2020 7/2/2020 07/02/2020
Misc
Informational
06/25/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
07/02/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
ADA Inspection Partial 7/2/2020 7/2/2020 07/02/2020
Misc
Informational
06/24/2020
Forms were placed and aggregate was present and compacted. RP 6-24-20
Misc
Informational
07/02/2020
Finished ADA ramps on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Pavement-Stabilized Subgrade Partial 7/2/2020 7/2/2020 07/02/2020
Misc
Informational
06/30/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
06/30/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
06/30/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
06/30/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
06/30/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
07/02/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Pavement-Proof Roll Partial 7/6/2020 7/6/2020 07/06/2020
Misc
Corrective Action Required
06/30/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
06/30/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
06/30/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Misc
Corrective Action Required
06/30/2020
Spalding had a tandem dump truck with a 20.1 ton load. Proof rolled the center section (O'Brien, Killarney and Ambersham). Most of the sub-grade passed, but we had numerous areas with little or extreme pumping. Brian is going to dig out the problem areas and add additional rock to those areas. RP 6-30-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 20.5 ton load. We proof rolled the new section on O’Brien and half of Ambersham. They are good to start pouring curbs for these sections. RP 7-6-20
Pavement-Stabilized Subgrade Partial 7/6/2020 7/6/2020 07/06/2020
Misc
Informational
07/02/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
07/02/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
07/02/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
07/02/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
07/02/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
07/02/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Misc
Informational
07/06/2020
Brought in another 300 tons of MODOT Type 5 rock to build the rock base for O’Brien, Ambersham and Killarney. RP 7-6-20
Storm - Outlet Structure Partial 7/6/2020 7/6/2020 07/06/2020
Misc
Corrective Action Required
07/06/2020
Jared from Redford was adjusting curb inlets for the center section (O’Brien, Shamrock and Killarney) when he came across box 6-3 being almost 1 foot off center. Talked with Gene Williams and Steve Robbins and it was determined that Redford needs to have their engineer design a different solution other than digging back up the roadway and moving the structure 1 foot. RP 7-6-20
Pavement-Curb Construction Partial 7/7/2020 7/7/2020 07/07/2020
Misc
Informational
06/25/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
06/25/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
06/25/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
06/25/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/07/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Pavement-Proof Roll Partial 7/8/2020 7/8/2020 07/08/2020
Misc
Corrective Action Required
07/06/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
07/06/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Misc
Corrective Action Required
07/06/2020
Spalding had a tandem dump truck with a 20.1 ton load. Proof rolled the center section (O'Brien, Killarney and Ambersham). Most of the sub-grade passed, but we had numerous areas with little or extreme pumping. Brian is going to dig out the problem areas and add additional rock to those areas. RP 6-30-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/06/2020
Spalding had a tandem dump truck with a 20.5 ton load. We proof rolled the new section on O’Brien and half of Ambersham. They are good to start pouring curbs for these sections. RP 7-6-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 20.5 ton load. Everything passed the curb proof roll except for a small section where new Ambersham connects to old Ambersham. We will re-roll that section before we place curbing. RP 7-8-20
Pavement-Curb Construction Partial 7/8/2020 7/8/2020 07/08/2020
Misc
Informational
07/07/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/07/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/07/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/07/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/07/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/08/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Pavement-Curb Construction Partial 7/10/2020 7/10/2020 07/10/2020
Misc
Informational
07/08/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/08/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/08/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/08/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/08/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/08/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
07/10/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Pavement-Curb Construction Partial 7/13/2020 7/13/2020 07/13/2020
Misc
Informational
07/10/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/10/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/10/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/10/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/10/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/10/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
07/10/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
07/13/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Pavement-Curb Construction Partial 7/14/2020 7/14/2020 07/14/2020
Misc
Informational
07/13/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/13/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/13/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/13/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/13/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/13/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
07/13/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
07/13/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
07/14/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Pavement-Curb Construction Partial 7/15/2020 7/15/2020 07/16/2020
Misc
Informational
07/14/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/14/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/14/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/14/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/14/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/14/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
07/14/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
07/14/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
07/14/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Misc
Informational
07/16/2020
They formed and poured the final 6 curb inlets on O’Brien, Ambersham and Killarney. RP 7-16-20
Pavement-Proof Roll Partial 7/17/2020 7/17/2020 07/17/2020
Misc
Corrective Action Required
07/08/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
07/08/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Misc
Corrective Action Required
07/08/2020
Spalding had a tandem dump truck with a 20.1 ton load. Proof rolled the center section (O'Brien, Killarney and Ambersham). Most of the sub-grade passed, but we had numerous areas with little or extreme pumping. Brian is going to dig out the problem areas and add additional rock to those areas. RP 6-30-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 20.5 ton load. We proof rolled the new section on O’Brien and half of Ambersham. They are good to start pouring curbs for these sections. RP 7-6-20
Misc
Informational
07/08/2020
Spalding had a tandem dump truck with a 20.5 ton load. Everything passed the curb proof roll except for a small section where new Ambersham connects to old Ambersham. We will re-roll that section before we place curbing. RP 7-8-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 19.6 ton load. We tested O’Brien, Ambersham and Killarney. Base was solid, no deflection was noticed. RP 7-17-20
Misc
Informational
07/22/2020
Spalding had a tandem dump truck with a 19.6 ton load. We tested O’Brien, Ambersham and Killarney. Base was solid, no deflection was noticed. RP 7-17-20
Pavement-Proof Roll Partial 7/23/2020 7/23/2020 07/23/2020
Misc
Corrective Action Required
07/17/2020
Spalding had a tandem dump truck with a 21.15 ton load. Brian from Spalding observed the proof roll with me. We had 5 to 6 sections that pumped badly under load pressure. Met with Steve Robbins to go over the soft sections. It was agreed upon to dig them up and fill them with geo grid an additional rock. RP 6-10-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 20 ton load. Had 1 section on Shamrock and 1 on Joshua that was a little soft. Talked with Jason about it and we decided to let it bake one more day. So we will be ready to lay curbs starting on Thursday. RP 6-16-20
Misc
Informational
07/17/2020
Had a tandem dump truck with a 20.8 ton load. Shamrock, Grady and Joshua finished sub-grade passed its proof roll. Superior Bowen is planning on laying asphalt base on Monday. RP 6-26-20
Misc
Corrective Action Required
07/17/2020
Spalding had a tandem dump truck with a 20.1 ton load. Proof rolled the center section (O'Brien, Killarney and Ambersham). Most of the sub-grade passed, but we had numerous areas with little or extreme pumping. Brian is going to dig out the problem areas and add additional rock to those areas. RP 6-30-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 28 ton load. We proof rolled the beginning section of O’Brien were the old pavement ended. Chemically treated sub-grade is good to add rock base. RP 7-6-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 20.5 ton load. We proof rolled the new section on O’Brien and half of Ambersham. They are good to start pouring curbs for these sections. RP 7-6-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 20.5 ton load. Everything passed the curb proof roll except for a small section where new Ambersham connects to old Ambersham. We will re-roll that section before we place curbing. RP 7-8-20
Misc
Informational
07/17/2020
Spalding had a tandem dump truck with a 19.6 ton load. We tested O’Brien, Ambersham and Killarney. Base was solid, no deflection was noticed. RP 7-17-20
Misc
Informational
07/23/2020
Proof rolled Ambersham, O’Brien and Killarney again due to this weeks rain. The roadways passed again. So Superior Bowen will be laying asphalt base tomorrow. RP 7-23-20
Pavement-Surface Partial 7/24/2020 7/24/2020 07/24/2020
Misc
Informational
06/29/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Misc
Informational
07/24/2020
Rick’s crew from Superior Bowen laid 1,609.77 tons of APWA Type 5 R ashphalt for the base on Killarney and Ambersham. RP 7-24-20
Pavement-Surface Partial 7/25/2020 7/25/2020 07/25/2020
Misc
Informational
07/24/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Misc
Informational
07/24/2020
Rick’s crew from Superior Bowen laid 1,609.77 tons of APWA Type 5 R ashphalt for the base on Killarney and Ambersham. RP 7-24-20
Misc
Informational
07/25/2020
Rick’s crew laid 1,450.55 tons of APWA Type 5 R base asphalt on Ambersham and O’Brien. RP 7-25-20
Street - Surface Course Partial 7/28/2020 7/28/2020 07/28/2020
Misc
Informational
07/28/2020
Rick’s crew from Superior Bowen laid 1,888 tons of APWA Type 5 V asphalt for the surface of O’Brien, Ambersham, Killarney, Shamrock, Grady and Joshua. RP 7-28-20
Erosion Control Inspection Failed 6/12/2020 6/12/2020 07/30/2020
Misc
Corrective Action Required
06/04/2020
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
06/04/2020
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
06/04/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Misc
Informational
06/04/2020
Silt has been swept up from the roadways. Welch Erosion still needs to repair erosion control devices. RP 5-29-20
Misc
Corrective Action Required
06/04/2020
SWWWP report from Welch Erosion had nothing listed for the erosion issues off of Ambersham last Thursday. RP 6-2-20
Misc
Informational
06/04/2020
No work is being done today due to last nights storm. No erosion issues and the fence that was down on Ambersham has been repaired. RP 6-4-20
Misc
Corrective Action Required
07/30/2020
Still need phase 2 erosion controls implemented. Also need curb inlets cleaned out and gutter buddies replaced and installed correctly. RP 7-30-20
Erosion Control Inspection Partial 7/31/2020 7/31/2020 07/31/2020
Misc
Corrective Action Required
07/30/2020
Silt is washing up on 113, 109, 105 and 101 NW Cody Dr. Silt fence is down in one spot. Might need to design a silt trap basin for this area. Silt was also washing down the field inlet behind 117 NW Cody Dr. RP 8-26-19
Misc
Corrective Action Required
07/30/2020
Silt fence protecting Ambersham off Whitman has washed out and is allowing silt to leave the work site. Fencing needs to be repaired and SWPPP needs to be re-evaluated to avoid further violations. Future violations could lead to stop work orders being issued. RP 8-28-19
Misc
Corrective Action Required
07/30/2020
Silt fence on Ambersham has been breeched in numerous spots, dumping silt down Ambersham and Whitlock. Need to get repair erosion control and remove silt from roadways. RP 5-28-20
Misc
Informational
07/30/2020
Silt has been swept up from the roadways. Welch Erosion still needs to repair erosion control devices. RP 5-29-20
Misc
Corrective Action Required
07/30/2020
SWWWP report from Welch Erosion had nothing listed for the erosion issues off of Ambersham last Thursday. RP 6-2-20
Misc
Informational
07/30/2020
No work is being done today due to last nights storm. No erosion issues and the fence that was down on Ambersham has been repaired. RP 6-4-20
Misc
Corrective Action Required
07/30/2020
Still need phase 2 erosion controls implemented. Also need curb inlets cleaned out and gutter buddies replaced and installed correctly. RP 7-30-20
Misc
Corrective Action Required
07/31/2020
Yesterday’s rain deposited a lot of silt on Whitlock, Joshua and Ambersham. Welch Erosion is on site cleaning curb inlets and checking perimeter fencing. I informed them on the silt in the roadways also. RP 7-31-20
Site Visit Partial 6/18/2020 6/18/2020 08/01/2020
Misc
Informational
06/17/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
06/17/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
08/01/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
ADA Inspection Partial 8/3/2020 8/3/2020 08/03/2020
Misc
Informational
07/02/2020
Forms were placed and aggregate was present and compacted. RP 6-24-20
Misc
Informational
07/02/2020
Finished ADA ramps on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
08/03/2020
JK Concrete set up for 11 ADA ramps (3 type B and 8 type A ramps) on O’Brien, Ambersham and Killarney. Forms were placed and aggregate was present and compacted. RP 8-3-20
Sidewalk Inspection Partial 8/3/2020 8/3/2020 08/04/2020
Misc
Informational
07/02/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
07/02/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
08/04/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Pavement-Stabilized Subgrade Partial 8/14/2020 8/14/2020 08/14/2020
Misc
Informational
07/06/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
07/06/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
07/06/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
07/06/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
07/06/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
07/06/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Misc
Informational
07/06/2020
Brought in another 300 tons of MODOT Type 5 rock to build the rock base for O’Brien, Ambersham and Killarney. RP 7-6-20
Misc
Informational
08/14/2020
Spalding applied 90 tons of Portland at 5% 6 inches deep for Ashurst and Kaylea. KC Testing was on site for testing. RP 8-14-20
Sidewalk Inspection Partial 8/14/2020 8/14/2020 08/18/2020
Misc
Informational
08/04/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
08/04/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
08/04/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
08/18/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
ADA Inspection Partial 8/14/2020 8/14/2020 08/18/2020
Misc
Informational
08/03/2020
Forms were placed and aggregate was present and compacted. RP 6-24-20
Misc
Informational
08/03/2020
Finished ADA ramps on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
08/03/2020
JK Concrete set up for 11 ADA ramps (3 type B and 8 type A ramps) on O’Brien, Ambersham and Killarney. Forms were placed and aggregate was present and compacted. RP 8-3-20
Misc
Informational
08/18/2020
ADA ramps on Ambersham, Killarney and O’Brien meets LS and ADA specs. RP 8-18-20
Pavement-Proof Roll Partial 8/18/2020 8/18/2020 08/18/2020
Misc
Informational
08/18/2020
Jason from Spalding had a tandem dump truck with a 20.2 ton load. We proof rolled Ashurst and Kaylea. Had 2 spots with minimal pumping. Jason said they will scoop those sections out and replace with additional rock. RP 8-18-20
Sanitary Sewer Construction Inspection Partial 8/18/2020 8/18/2020 08/18/2020
Misc
Informational
03/03/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
03/03/2020
Branden’s crew blew a hydraulic line, so they were only able to get 2 sticks laid today. RP 8-9-19
Misc
Informational
03/03/2020
Jim’s crew finally reached and set manhole #1-3. They continue to break rock setting sanitary pipe. RP 8-13-19
Misc
Informational
03/03/2020
Branden and Jake are still breaking rock. They set 3 sticks of sanitary pipe today. RP 8-5-19
Misc
Informational
03/03/2020
Branden’s crew laid 4 sticks of sanitary pipe today. Talked with Branden about back fill material. No rock more than 3 inches for the first foot. Rock can be mixed with soil up to 50 percent of the middle section of back fill. No rock is allowed in the last 2 feet of back fill. They are still busting rock. RP 8-6-19
Misc
Informational
03/03/2020
Branden’s crew got another 4 sticks of sanitary pipe laid today. He is mixing soil with the rock for the middle section of backfill. RP 8-8-19
Misc
Informational
03/03/2020
Jim’s crew got 3 sticks laid today out of manhole #1-3. RP 8-14-19
Misc
Informational
03/03/2020
Jim’s crew is 60 ft short of manhole #1-4 on sanitary sewer line 1. They also have sanitary sewer line 2 up to manhole #2-1 set
Misc
Informational
03/03/2020
The encasement for the creek crossing has been completed and the ductile iron pipe was installed from the existing MH to MH a-1 which is the first MH. The MH has been set and they are now continuing on to the next MH. The have hit a lot of rock and are not moving very fast.Steve Robbins 07/26/2019 4:20 PM
Misc
Informational
03/03/2020
The core drill for the existing MH has also been completed, I forgot to put that in the first inspection. MH 1-1 has been installed and they are still hitting alot of rock, they only installed about 2 sticks of pipe. They are working toward 1-2.
Misc
Informational
03/03/2020
Manhole 1-2 has been set. Still hammering through rock working their way towards MH 1-3. RP 8-2-19
Misc
Informational
03/03/2020
Manhole #2-2 was hit with rock and cracked the inside and outside of manhole. Jim has ordered another manhole. It should be here on Tuesday 8-27-19.
Misc
Informational
03/03/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
03/03/2020
Jim’s crew encased the drop on manhole #2-1, set manhole #2-3 and laid 10 sticks of sanitary pipe. RP 8-23-19
Misc
Informational
03/03/2020
Jim has 2 crews working on the sanitary line now. They laid 200 ft of sanitary main line along with laterals for lots 57, 56, 55, 65 and 66. RP 8-27-19
Misc
Informational
03/03/2020
Jim’s crews laid 300 ft of sanitary pipe today. They set manholes #2-4 and #2-5. They set sanitary laterals for lots 54, 68, 53, 52, 51 and 48. KC Testing was checking density levels for road crossings. Optimum moisture levels were high, so they will check again tomorrow. RP 8-28-19
Misc
Informational
03/03/2020
Jim’s crew has laid 780 ft of sanitary pipe. They have also set manholes 1-5, 1-6, 1-7, 1-8 ,1-9 and 1-10. RP 9-23-19
Misc
Informational
03/03/2020
Jim’s crew set manholes 1-11 and 1-12. They also laid 600 ft of sanitary pipe and concrete encased 20 ft of sanitary pipe. RP 9-27-19
Misc
Informational
03/03/2020
Jim’s crew laid 300 ft of sanitary pipe on sanitary line 1 and sanitary line 4. They set manhole 1-13. They also set laterals for lots 75, 74, 73, 88, 89, 90 and 121. RP 10-1-19
Misc
Informational
03/03/2020
Darren’s crew set manhole 4-1 and completed sanitary line 4. They are now working on sanitary line 3. They are still encountering rock when laying the pipe. RP 10-18-19
Misc
Informational
03/03/2020
Darren’s crew laid 120 ft of sanitary pipe on line 3. They also set laterals for lots 131, 139, 132 and 138. Jim’s crew laid 145 ft of sanitary pipe. They also set manholes 8-2 and 8-3 along with laterals 105, 108 and 104. RP 10-22-19
Misc
Informational
03/03/2020
Darren’s crew laid 181 ft of sanitary pipe and set manhole 3-2. They also set laterals for lots 133, 134, 135, 137 and 136. Jim’s crew laid 120 ft of sanitary pipe and set manhole 8-4. They also laid laterals for lots 103, 109, 102, 110 and 111. RP 10-24-19
Misc
Informational
03/03/2020
Jim’s crew is still fighting rock while laying pipe. They got 60 ft laid on sanitary line 8 along with laterals for lot 101. RP 10-25-19
Misc
Informational
03/03/2020
Jim’s crew laid 350 ft of sanitary pipe. They set manhole 8-5. They also set laterals for lots 112, 100, 113, 99, 114 and 98. RP 11-1-19
Misc
Informational
03/03/2020
Jim’s crew continued to break rock and lay sanitary pipe on line 8. Darren’s crew bore into existing manhole 28-103. They also set manhole 11-1 and laid sanitary pipe on line 11. RP 11-4-19
Misc
Informational
03/03/2020
Jim’s crew is still breaking rock and working on line 8. Darren’s crew also ran into rock on line 11. RP 11-5-19
Misc
Informational
03/03/2020
Jim’s crew set manhole 8-6 and laterals for lots 95, 116 and 94. Darren’s crew set manhole 11-2. RP 11-6-19
Misc
Informational
03/03/2020
Jim’s crew laid sanitary pipe on line 8 and laterals for lots 117 and 93. Darren’s crew is still breaking rock on line 11. RP 11-7-19
Misc
Informational
03/03/2020
Jim’s crew set manhole 8-7 and laterals for lots 118 and 92. Darren’s crew is still breaking rock on line 11. RP 11-8-19
Misc
Informational
03/03/2020
Darren’s crew set manhole 11-3. Jim’s crew set manhole 8-7. RP 11-12-19
Misc
Informational
03/03/2020
Jim’s crew open cut Whitlock Dr and set manhole 8-0. RP 11-14-19
Misc
Informational
03/03/2020
Jim’s crew encountered the existing water line, which will be in the way of the sanitary line. Engineers will need to resubmit new plans on how to proceed. RP 11-15-19
Misc
Informational
03/03/2020
Darren’s crew is still busting 13 ft of rock to set sanitary line 12. They have set 60 ft of 8 inch SDR 26 sanitary pipe. RP 11-27-19
Misc
Informational
03/03/2020
Darren’s crew set sanitary manhole 12-1. They are continuing to break rock on lines 12 and 13. RP 12-2-19
Misc
Informational
03/03/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
03/03/2020
Darren’s crew has set manholes 12-2 and 12-3. They also laid 250 ft of 8 inch sanitary pipe, along with laterals for lots 19, 20 and 44. They are still encountering rock along the way. RP 12-10-19
Misc
Informational
03/03/2020
Jim’s crew has laid 80 ft of sanitary pipe on Line 8. Darren’s crew has set manhole 12-4 and laterals for lots 42, 41, 40, 39, 25, 24, 23 and 22. RP 12-27-19
Misc
Informational
03/03/2020
Darren’s crew has been working on sanitary line 10. They have cored into existing manhole 28-100, along with setting manholes 10-1, 10-2 and 10-3. Jim’s crew is working on sanitary line 9. They have bored into existing manhole 28-099 and they have set manholes 9-1 and 9-2. RP 2-11-20
Misc
Informational
03/03/2020
Darren’s crew set manhole 10-4 along with service laterals. Jim’s crew set manholes 9-3 and 9-4. 9-3 drop is supported with rebar. They will pour the inverts and encase the drop with concrete tomorrow. RP 2-19-20
Misc
Informational
03/03/2020
Darren’s crew set manhole 10-5 which completed sanitary line 10. Jim’s crew set manholes 9-5 and 9-6. RP 2-27-20
Misc
Informational
03/03/2020
Jim’s crew set manhole 9-7. Darren’s crew is laying sanitary pipe out of manhole 11-4. RP 3-2-20
Misc
Informational
03/03/2020
Darren’s crew set manhole 11-5, which completed sanitary line 11. All they have remaining is sanitary line 13 to install. Jim’s crew set manhole 9-8. They are now going back to install the service laterals for lots 72, 71, 70 and 69. RP 3-3-20
Misc
Informational
08/18/2020
Jarrod’s crew repaired sags on the sanitary line on Ashurst. RP 8-18-20
Pavement-Stabilized Subgrade Partial 8/19/2020 8/19/2020 08/19/2020
Misc
Informational
08/14/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
08/14/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
08/14/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
08/14/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
08/14/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
08/14/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Misc
Informational
08/14/2020
Brought in another 300 tons of MODOT Type 5 rock to build the rock base for O’Brien, Ambersham and Killarney. RP 7-6-20
Misc
Informational
08/14/2020
Spalding applied 90 tons of Portland at 5% 6 inches deep for Ashurst and Kaylea. KC Testing was on site for testing. RP 8-14-20
Misc
Informational
08/19/2020
Brian’s crew laid down 2,200 tons of MODOT Type 5 rock from Ashurst and Kaylea. RP 8-19-20
Pavement-Proof Roll Passed 8/24/2020 08/24/2020
Misc
Informational
08/18/2020
Jason from Spalding had a tandem dump truck with a 20.2 ton load. We proof rolled Ashurst and Kaylea. Had 2 spots with minimal pumping. Jason said they will scoop those sections out and replace with additional rock. RP 8-18-20
Misc
Informational
08/24/2020
Did a proof roll with a truck that had a ticket with 20.34 tons. The rock had been sitting since last wednesday. The subgrade was very solid and the proof roll passed with no issues.
Pavement-Curb Construction Partial 8/25/2020 08/26/2020
Misc
Informational
07/16/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
07/16/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
07/16/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
07/16/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
07/16/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
07/16/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
07/16/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
07/16/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
07/16/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Misc
Informational
07/16/2020
They formed and poured the final 6 curb inlets on O’Brien, Ambersham and Killarney. RP 7-16-20
Misc
Informational
08/26/2020
After a curb proofroll was passed JK concrete came out and poured curbs with the curb machine on Ashurst and Kayela Ct. The testing company was on site and will send the results to Redford along with the receipt tickets for the KCMMB Concrete mix. They will then forward these on to Ron. I am going to give this a partial until we receive all the paperwork and test results.
Storm Sewer Construction Inspection Partial 8/26/2020 08/26/2020
Misc
Informational
08/26/2020
The contractors are installing the throats of the curb inlets and connecting to the existing new curbs installed yesterday. I let them know to vibrate concrete and make sure they have plenty of white cure. They are using KCMBB Granite mix and should be finished later this afternoon.
Storm - Pipe Partial 8/26/2020 08/26/2020
Misc
Informational
06/16/2020
Redford cut into the roadway and set under drains across Joshua and Grady. RP 6-15-20
Misc
Informational
08/26/2020
The completed the road drain on ashurst. They have finished pouring all the throats and curbs for the curb inlets on ashurst and kayala ct. They will need to come back and grout around the lids.
Pavement-Proof Roll Passed 08/28/2020
Misc
Informational
08/28/2020
John DiMauro 8/28/2020 3:15 PM I observed the proof roll for the through street section of NW ASHURST DR and attached cul-de-sac. I verified an acceptable load weight on the ticket and the roll test passed with no deflection. A copy of the ticket has been uploaded.
Storm - Pipe Partial 8/27/2020 08/31/2020
Misc
Informational
08/26/2020
Redford cut into the roadway and set under drains across Joshua and Grady. RP 6-15-20
Misc
Informational
08/26/2020
Theycompleted the road drain on ashurst. They have finished pouring all the throats and curbs for the curb inlets on ashurst and kayala ct. They will need to come back and grout around the lids.
Hydrant Inspection Partial 8/27/2020 08/31/2020
Misc
Informational
08/31/2020
The existing fire hydrant (21522) on Pryor/O'brien has been moved back 10 ft. so when the sidewalk is moved over it the valve and hydrant will not be in the sidewalk path. Greg and Chuck turned off the water, no on was affected. I turned the water back on when the work was complete. The thrust block was poured and had time to set up. The hydrant appears to be low right now, we are going to wait and see when the sidewalk is in it may need to be raised.
Pavement-Stabilized Subgrade Partial 8/28/2020 08/31/2020
Misc
Informational
08/19/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
08/19/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
08/19/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
08/19/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
08/19/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
08/19/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Misc
Informational
08/19/2020
Brought in another 300 tons of MODOT Type 5 rock to build the rock base for O’Brien, Ambersham and Killarney. RP 7-6-20
Misc
Informational
08/19/2020
Spalding applied 90 tons of Portland at 5% 6 inches deep for Ashurst and Kaylea. KC Testing was on site for testing. RP 8-14-20
Misc
Informational
08/19/2020
Brian’s crew laid down 2,200 tons of MODOT Type 5 rock from Ashurst and Kaylea. RP 8-19-20
Misc
Informational
08/31/2020
Starting on 8/26 / Spalding saw cut pryor road. They then dug up the curb and part of the road getting ready to install the turn lane. So far they have installed geo-grid and at least 6" of rock up to O'Brien, as they are now digging and getting ready to install more geo-grid and rock around the corner. Spalding did not work today due to the rain.
Pavement-Surface Partial 8/31/2020 08/31/2020
Misc
Informational
07/25/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Misc
Informational
07/25/2020
Rick’s crew from Superior Bowen laid 1,609.77 tons of APWA Type 5 R ashphalt for the base on Killarney and Ambersham. RP 7-24-20
Misc
Informational
07/25/2020
Rick’s crew laid 1,450.55 tons of APWA Type 5 R base asphalt on Ambersham and O’Brien. RP 7-25-20
Misc
Informational
08/31/2020
Base aphalt was scheduled to go in on Saturday 8/29 on Ashurst but did not due to rain. Nothing went in today due to the rain. I drove out and it appeared to have some puddles by Pryor and Ashurst. We wil probably need to elavuate a proofroll before ashphalt can go in.
Pavement-Stabilized Subgrade Partial 9/2/2020 9/2/2020 09/02/2020
Misc
Informational
08/31/2020
Brian tilled in 5% Portland cement, 6 inches deep. KC Testing was out here monitoring and taking test samples. Tentative plan for proof rolling is next Monday afternoon. RP 6-3-20
Misc
Informational
08/31/2020
Spalding has started laying and rolling the rock base. RP 6-11-20
Misc
Informational
08/31/2020
Spalding has got all the rock down and rolled / graded in. Just need to let in set up and bake now. RP 6-12-20
Misc
Informational
08/31/2020
Brian’s crew tilled in 5% Portland concrete 6 inches deep on the center section of Woodside Ridge (O’Brien, Ambersham and Killarney). KC Testing was on site to check compaction. They hit the AT&T line crossing Ambersham. AT&T is digging an trench across the roadway to splice in the new line. RP 6-24-20
Misc
Informational
08/31/2020
Brian’s crew started laying MODOT type 5 rock on O’Brien, Killarney and Ambersham. RP 6-30-20
Misc
Informational
08/31/2020
Tilled in 5% Portland 9 inches deep on O’Brien were the new roadway meets the old existing roadway. Tester’s were on site testing compaction. RP 7-2-20
Misc
Informational
08/31/2020
Brought in another 300 tons of MODOT Type 5 rock to build the rock base for O’Brien, Ambersham and Killarney. RP 7-6-20
Misc
Informational
08/31/2020
Spalding applied 90 tons of Portland at 5% 6 inches deep for Ashurst and Kaylea. KC Testing was on site for testing. RP 8-14-20
Misc
Informational
08/31/2020
Brian’s crew laid down 2,200 tons of MODOT Type 5 rock from Ashurst and Kaylea. RP 8-19-20
Misc
Informational
08/31/2020
Starting on 8/26 / Spalding saw cut pryor road. They then dug up the curb and part of the road getting ready to install the turn lane. So far they have installed geo-grid and at least 6" of rock up to O'Brien, as they are now digging and getting ready to install more geo-grid and rock around the corner. Spalding did not work today due to the rain.
Misc
Informational
09/02/2020
Brian’s crew from Randy Spalding is laying geo grid and 6 inches of MODOT Type 5 for the turn lanes at O’Brien and Pryor. RP 9-2-20
Pavement-Surface Partial 9/3/2020 9/3/2020 09/03/2020
Misc
Informational
08/31/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Misc
Informational
08/31/2020
Rick’s crew from Superior Bowen laid 1,609.77 tons of APWA Type 5 R ashphalt for the base on Killarney and Ambersham. RP 7-24-20
Misc
Informational
08/31/2020
Rick’s crew laid 1,450.55 tons of APWA Type 5 R base asphalt on Ambersham and O’Brien. RP 7-25-20
Misc
Informational
08/31/2020
Base aphalt was scheduled to go in on Saturday 8/29 on Ashurst but did not due to rain. Nothing went in today due to the rain. I drove out and it appeared to have some puddles by Pryor and Ashurst. We wil probably need to elavuate a proofroll before ashphalt can go in.
Misc
Informational
09/03/2020
Brad’s crew from Superior Bowen laid 1,103 tons of APWA Type 5 R asphalt for the base on Ashurst and Kaylea. KC Testing will be out later today for compaction testing. They were at the plant testing the product earlier today. RP 9-3-20
Street - Surface Course Partial 9/4/2020 9/4/2020 09/04/2020
Misc
Informational
07/28/2020
Rick’s crew from Superior Bowen laid 1,888 tons of APWA Type 5 V asphalt for the surface of O’Brien, Ambersham, Killarney, Shamrock, Grady and Joshua. RP 7-28-20
Misc
Informational
09/04/2020
Brad’s crew laid 602 tons of APWA Type 5 V asphalt on Ashurst and Kaylea. KC Testing was on site for compaction testing. RP 9-4-20
Pavement-Curb Construction Partial 9/15/2020 9/15/2020 09/15/2020
Misc
Informational
08/26/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
08/26/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
08/26/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
08/26/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
08/26/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
08/26/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
08/26/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
08/26/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
08/26/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Misc
Informational
08/26/2020
They formed and poured the final 6 curb inlets on O’Brien, Ambersham and Killarney. RP 7-16-20
Misc
Informational
08/26/2020
After a curb proofroll was passed JK concrete came out and poured curbs with the curb machine on Ashurst and Kayela Ct. The testing company was on site and will send the results to Redford along with the receipt tickets for the KCMMB Concrete mix. They will then forward these on to Ron. I am going to give this a partial until we receive all the paperwork and test results.
Misc
Informational
09/15/2020
Brad’s crew from JK Concrete formed and poured curbs on the west side of Pryor and O’Brien. They still need to remove and replace curbs on the east side of the intersection. RP 9-15-20
Water - Material Verification Passed 9/15/2020 9/15/2020 09/15/2020
Misc
Informational
09/15/2020
They are using C900 pipe from Anderson. Fire Hydrants are Kennedy 250CWP. Fittings and connections are using mega lugs. RP 9-15-20
Water Line - Construction Inspection Partial 9/15/2020 9/15/2020 09/15/2020
Misc
Informational
05/06/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
05/06/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
05/06/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
05/06/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
05/06/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
05/06/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
05/06/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
05/06/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
05/06/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
05/06/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/15/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Water Line - Construction Inspection Partial 9/16/2020 9/16/2020 09/16/2020
Misc
Informational
09/15/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
09/15/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
09/15/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/15/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/15/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
09/15/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
09/15/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
09/15/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
09/15/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
09/15/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/15/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Misc
Informational
09/16/2020
Kyle’s crew from Redford laid another 400 feet of C900 pipe. They also set 2 fire hydrants on Ashurst. RP 9-16-20
Water Line - Construction Inspection Partial 9/17/2020 9/17/2020 09/18/2020
Misc
Informational
09/16/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
09/16/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
09/16/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/16/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/16/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
09/16/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
09/16/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
09/16/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
09/16/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
09/16/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/16/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Misc
Informational
09/16/2020
Kyle’s crew from Redford laid another 400 feet of C900 pipe. They also set 2 fire hydrants on Ashurst. RP 9-16-20
Misc
Informational
09/18/2020
Kyle’s crew laid another 300 feet of C900 pipe on line 10 up to the tee at Kaylea. RP 9-17-20
Water Line - Construction Inspection Partial 9/18/2020 9/18/2020 09/18/2020
Misc
Informational
09/18/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
09/18/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/18/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
09/18/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
09/18/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
09/18/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
09/18/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/18/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Misc
Informational
09/18/2020
Kyle’s crew from Redford laid another 400 feet of C900 pipe. They also set 2 fire hydrants on Ashurst. RP 9-16-20
Misc
Informational
09/18/2020
Kyle’s crew laid another 300 feet of C900 pipe on line 10 up to the tee at Kaylea. RP 9-17-20
Misc
Informational
09/18/2020
Kyle’s crew laid 160 feet of 6 inch C900 pipe on line 11. They also poured thrust blocks for both fire hydrants, tee and bends on line 10. RP 9-18-20
Water Line - Construction Inspection Partial 9/21/2020 9/21/2020 09/21/2020
Misc
Informational
09/18/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
09/18/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/18/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
09/18/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
09/18/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
09/18/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
09/18/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
09/18/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/18/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Misc
Informational
09/18/2020
Kyle’s crew from Redford laid another 400 feet of C900 pipe. They also set 2 fire hydrants on Ashurst. RP 9-16-20
Misc
Informational
09/18/2020
Kyle’s crew laid another 300 feet of C900 pipe on line 10 up to the tee at Kaylea. RP 9-17-20
Misc
Informational
09/18/2020
Kyle’s crew laid 160 feet of 6 inch C900 pipe on line 11. They also poured thrust blocks for both fire hydrants, tee and bends on line 10. RP 9-18-20
Misc
Informational
09/21/2020
Kyle’s crew finished laying line 11 and it’s fire hydrant. RP 9-21-20
Water Line - Construction Inspection Partial 9/22/2020 9/22/2020 09/22/2020
Misc
Informational
09/21/2020
Jesse’s crew from Redford Construction has laid water lines 1, 2, and 3. We eliminated the fire hydrant at the end of line 2 due the close proximity of the fire hydrant at the entrance to the new fire station. RP 2-10-20
Misc
Informational
09/21/2020
Jim’s crew laid 350 ft of water line 6. RP 3-25-20
Misc
Informational
09/21/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/21/2020
Jimmy’s crew finished laying line 6 and have started on line 5. RP 3-30-20
Misc
Informational
09/21/2020
Jimmy’s crew laid water line 5 and the dead end section of line 7. RP 3-31-20
Misc
Informational
09/21/2020
Jimmy’s crew started laying water line 4. They also installed the fire hydrants on lines 5, 6, and 7. RP 4-2-20
Misc
Informational
09/21/2020
Jimmy’s crew has finished water line 7 and most of line 4 and removed old line and connected into our main for line 9. RP 4-9-20
Misc
Informational
09/21/2020
Jimmy’s crew finished laying water line 9. RP 4-14-20
Misc
Informational
09/21/2020
Line 4 has been completely installed. RP 4-21-20
Misc
Informational
09/21/2020
Tied in the water lines at O’Brien and Ambersham to the city main. RP 5-6-20
Misc
Informational
09/21/2020
Redford’s crew laid 500 ft of C900 on water line 10. RP 9-15-20
Misc
Informational
09/21/2020
Kyle’s crew from Redford laid another 400 feet of C900 pipe. They also set 2 fire hydrants on Ashurst. RP 9-16-20
Misc
Informational
09/21/2020
Kyle’s crew laid another 300 feet of C900 pipe on line 10 up to the tee at Kaylea. RP 9-17-20
Misc
Informational
09/21/2020
Kyle’s crew laid 160 feet of 6 inch C900 pipe on line 11. They also poured thrust blocks for both fire hydrants, tee and bends on line 10. RP 9-18-20
Misc
Informational
09/21/2020
Kyle’s crew finished laying line 11 and it’s fire hydrant. RP 9-21-20
Misc
Informational
09/22/2020
Grant’s crew finished laying line 10 up to where the old line dead ended on Ashurst. They also poured straddle block and kickers for bends and hydrants. RP 9-22-20
Street - Concrete Partial 9/22/2020 9/22/2020 09/22/2020
Misc
Informational
09/22/2020
JK Concrete poured the southbound turn lane for Pryor and O’Brien. KC Testing was on site conducting concrete testing. RP 9-22-20
Street - Concrete Partial 9/23/2020 9/23/2020 09/23/2020
Misc
Informational
09/22/2020
JK Concrete poured the southbound turn lane for Pryor and O’Brien. KC Testing was on site conducting concrete testing. RP 9-22-20
Misc
Informational
09/23/2020
Brad’s crew from JK Concrete poured the concrete drive approach for the vacant lot on the north side of O’Brien. RP 9-23-20
Sidewalk Inspection Partial 9/23/2020 9/23/2020 09/23/2020
Misc
Informational
08/18/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
08/18/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
08/18/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
08/18/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
09/23/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Site Visit Partial 9/25/2020 9/25/2020 09/25/2020
Misc
Informational
08/01/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
08/01/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
08/01/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
09/25/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Water Line - Hydrostatic Test Passed 9/28/2020 9/28/2020 09/28/2020
Misc
Informational
04/23/2020
The water line off of Shamrock (south end of Woodside Ridge) held pressure over 150 PSI for 2 hrs. RP 2-28-20
Misc
Informational
04/23/2020
Water lines 4, 5, 6, 7, 8 and 9 held 150 PSI for 2 hours. RP 4-23-20
Misc
Informational
09/28/2020
Water lines 10 and 11 held over 150 PSI for 2 hours. RP 9-28-20
Water Line - Coliform Test 1 Partial 9/28/2020 9/28/2020 09/28/2020
Misc
Informational
05/04/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Misc
Informational
05/04/2020
First retest of dead end section of line 9 passed it’s Bac T test. RP 5-4-20
Misc
Informational
09/28/2020
Chlorinated lines 1, 10 and 11. RP 9-28-20
Site Visit Partial 9/28/2020 9/28/2020 09/29/2020
Misc
Informational
09/25/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
09/25/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
09/25/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
09/25/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
09/29/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Sanitary Sewer - Vacuum Partial 9/29/2020 9/29/2020 09/29/2020
Misc
Informational
04/23/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
04/23/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
04/23/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
04/23/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
04/23/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
04/23/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Misc
Informational
04/23/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/23/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
04/23/2020
Manhole 10-1 passed it’s vacuum test. The following manholes passed their vacuum test but needs to be retested once they are back filled to grade: 10-2, 10-3, 10-4, 10-5, 12-1, 12-2, 12-3, 12-4 and12-5. Manhole 11-3 passed its retest, but needs to be retested once it is back filled to grade. Manhole 11-2 FAILED again and needs to retested once it’s repaired. RP 4-16-20
Misc
Informational
04/23/2020
Currently all sanitary manholes have passed their vacuum test. Will have to retest manholes on sanitary lines 10, 11, 12 and 13 once the area has been back filled to the proper grade. RP 4-22-20
Misc
Informational
09/29/2020
We vacuum tested manholes 10-1, 10-2, 10-3 ,10-4, 10-5, 12-5 and 12-4 today. There were no problems. RP 9-29-20
Water Line - Coliform Test 1 Partial 9/29/2020 9/29/2020 09/29/2020
Misc
Informational
09/28/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Misc
Informational
09/28/2020
First retest of dead end section of line 9 passed it’s Bac T test. RP 5-4-20
Misc
Informational
09/28/2020
Chlorinated lines 1, 10 and 11. RP 9-28-20
Misc
Informational
09/29/2020
Joe Starlin help me dechlorinate water lines 1, 10 and 11. We can pull water samples any time after 8AM tomorrow. RP 9-29-30
Water Line - Coliform Test 1 Partial 9/30/2020 9/30/2020 09/30/2020
Misc
Informational
09/29/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Misc
Informational
09/29/2020
First retest of dead end section of line 9 passed it’s Bac T test. RP 5-4-20
Misc
Informational
09/29/2020
Chlorinated lines 1, 10 and 11. RP 9-28-20
Misc
Informational
09/29/2020
Joe Starlin help me dechlorinate water lines 1, 10 and 11. We can pull water samples any time after 8AM tomorrow. RP 9-29-30
Misc
Informational
09/30/2020
Meet with Daniel from Redford. We pulled samples from water line 1, 10 and 11. Delivered the samples to Keystone Laboratories for testing. RP 9-30-20
Sanitary Sewer - Vacuum Partial 10/1/2020 10/1/2020 10/01/2020
Misc
Informational
09/29/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
09/29/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
09/29/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
09/29/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
09/29/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
09/29/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Misc
Informational
09/29/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
09/29/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
09/29/2020
Manhole 10-1 passed it’s vacuum test. The following manholes passed their vacuum test but needs to be retested once they are back filled to grade: 10-2, 10-3, 10-4, 10-5, 12-1, 12-2, 12-3, 12-4 and12-5. Manhole 11-3 passed its retest, but needs to be retested once it is back filled to grade. Manhole 11-2 FAILED again and needs to retested once it’s repaired. RP 4-16-20
Misc
Informational
09/29/2020
Currently all sanitary manholes have passed their vacuum test. Will have to retest manholes on sanitary lines 10, 11, 12 and 13 once the area has been back filled to the proper grade. RP 4-22-20
Misc
Informational
09/29/2020
We vacuum tested manholes 10-1, 10-2, 10-3 ,10-4, 10-5, 12-5 and 12-4 today. There were no problems. RP 9-29-20
Misc
Informational
10/01/2020
Meet with Daniel and tested manholes 12-3, 12-4, 11-1 and 11-2. All manholes passed their vacuum test. Still need to test manholes 11-3 and 11-4, but Daniel needs to replace busted ring on 11-4 and add a ring to 11-3. RP 10-1-20
Water Line - Coliform Test 2 Partial 10/1/2020 10/1/2020 10/01/2020
Misc
Informational
05/04/2020
Pulled second samples for Bac T testing. RP 4-28-20
Misc
Informational
05/04/2020
The dead end section of line 9 failed the second test. The rest of the lines passed. We will be retesting line 9. RP 4-30-20
Misc
Informational
05/04/2020
Pulled second sample from dead end section of line 9. Delivered sample to Keystone Laboratories. Still waiting to hear if the first sample has passed yet. RP 5-1-20
Misc
Informational
05/04/2020
Dead end section of line 9 passed its second Bac T test. RP 5-4-20
Misc
Informational
10/01/2020
Meet with Daniel and pulled 3 water samples for second Bac T testing. Delivered the samples to Keystone Laboratories. Still waiting to hear back from the first samples. RP 10-1-20
Pavement-Surface Partial 10/1/2020 10/1/2020 10/01/2020
Misc
Informational
09/03/2020
Brian’s crew from Superior Bowen laid 1,100 tons of APWA Type 5 R asphalt for the base on Shamrock, Grady and Joshua. RP 6-29-20
Misc
Informational
09/03/2020
Rick’s crew from Superior Bowen laid 1,609.77 tons of APWA Type 5 R ashphalt for the base on Killarney and Ambersham. RP 7-24-20
Misc
Informational
09/03/2020
Rick’s crew laid 1,450.55 tons of APWA Type 5 R base asphalt on Ambersham and O’Brien. RP 7-25-20
Misc
Informational
09/03/2020
Base aphalt was scheduled to go in on Saturday 8/29 on Ashurst but did not due to rain. Nothing went in today due to the rain. I drove out and it appeared to have some puddles by Pryor and Ashurst. We wil probably need to elavuate a proofroll before ashphalt can go in.
Misc
Informational
09/03/2020
Brad’s crew from Superior Bowen laid 1,103 tons of APWA Type 5 R asphalt for the base on Ashurst and Kaylea. KC Testing will be out later today for compaction testing. They were at the plant testing the product earlier today. RP 9-3-20
Misc
Informational
10/01/2020
Superior Bowen milled out the damaged area of O’Brien and applied 161 tons of APWA Type 5 Recycled asphalt 7 inches deep for the base. CMTG was on site taking compaction test. RP 10-1-20
Street - Surface Course Partial 10/1/2020 10/1/2020 10/01/2020
Misc
Informational
09/04/2020
Rick’s crew from Superior Bowen laid 1,888 tons of APWA Type 5 V asphalt for the surface of O’Brien, Ambersham, Killarney, Shamrock, Grady and Joshua. RP 7-28-20
Misc
Informational
09/04/2020
Brad’s crew laid 602 tons of APWA Type 5 V asphalt on Ashurst and Kaylea. KC Testing was on site for compaction testing. RP 9-4-20
Misc
Informational
10/01/2020
Superior Bowen applied 156 tons of APWA Type 5 Virgin asphalt 2 inches deep for the surface of O’Brien. CMTG was on site taking compaction test. RP 10-1-20
Water Line - Coliform Test 1 Passed 10/2/2020 10/2/2020 10/02/2020
Misc
Informational
09/30/2020
Pulled sample from dead end hydrant on line 9. Took sample to Keystone Laboratories for testing. RP 4-30-20
Misc
Informational
09/30/2020
First retest of dead end section of line 9 passed it’s Bac T test. RP 5-4-20
Misc
Informational
09/30/2020
Chlorinated lines 1, 10 and 11. RP 9-28-20
Misc
Informational
09/30/2020
Joe Starlin help me dechlorinate water lines 1, 10 and 11. We can pull water samples any time after 8AM tomorrow. RP 9-29-30
Misc
Informational
09/30/2020
Meet with Daniel from Redford. We pulled samples from water line 1, 10 and 11. Delivered the samples to Keystone Laboratories for testing. RP 9-30-20
Misc
Informational
10/02/2020
Samples from Ashurst, Kaylea and Joshua all passed the first Bac T testing by Keystone Laboratories. RP 10-2-20
Sanitary Sewer - Vacuum Passed 10/2/2020 10/2/2020 10/02/2020
Misc
Informational
10/01/2020
Manhole 2-2 held 10 PSI for over 3 minutes. RP 12-4-19
Misc
Informational
10/01/2020
Manholes 1-1, 1-2, 1-3, 1-4 and 1-5 all passed vacuum testing. RP 1-7-2020
Misc
Informational
10/01/2020
The following manholes held for 2 1/2 minutes. 1-6, 1-7, 3-2. Manhole 3-1 FAILED the test and will need to be retested once it’s been repaired. RP 2-7-20
Misc
Informational
10/01/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
10/01/2020
The following manholes passed their vacuum test: 1-8, 1-9, 1-10, 1-11, 1-12, 1-13, 3-1 and 4-1. RP 3-5-20
Misc
Informational
10/01/2020
The following manholes passed their vacuum test: 8-0, 8-1, 8-2, 8-3, 8-4, 8-5, 8-6 and 8-7. RP 3-6-20
Misc
Informational
10/01/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
10/01/2020
Manhole 11-5 passed its vacuum test. Manholes 11-4 and 11-1 passed, but need to be retested after they are back filled to grade. Manholes 11-3 and 11-2 failed to hold pressure and needs to be retested. RP 4-14-20
Misc
Informational
10/01/2020
Manhole 10-1 passed it’s vacuum test. The following manholes passed their vacuum test but needs to be retested once they are back filled to grade: 10-2, 10-3, 10-4, 10-5, 12-1, 12-2, 12-3, 12-4 and12-5. Manhole 11-3 passed its retest, but needs to be retested once it is back filled to grade. Manhole 11-2 FAILED again and needs to retested once it’s repaired. RP 4-16-20
Misc
Informational
10/01/2020
Currently all sanitary manholes have passed their vacuum test. Will have to retest manholes on sanitary lines 10, 11, 12 and 13 once the area has been back filled to the proper grade. RP 4-22-20
Misc
Informational
10/01/2020
We vacuum tested manholes 10-1, 10-2, 10-3 ,10-4, 10-5, 12-5 and 12-4 today. There were no problems. RP 9-29-20
Misc
Informational
10/01/2020
Meet with Daniel and tested manholes 12-3, 12-4, 11-1 and 11-2. All manholes passed their vacuum test. Still need to test manholes 11-3 and 11-4, but Daniel needs to replace busted ring on 11-4 and add a ring to 11-3. RP 10-1-20
Misc
Informational
10/02/2020
Daniel replaced the rings on the last 2 manholes. They both passed the vacuum test. RP 10-2-20
Sidewalk Inspection Partial 10/2/2020 10/2/2020 10/05/2020
Misc
Informational
09/23/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
09/23/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
09/23/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
09/23/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
09/23/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
10/05/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side.
Sidewalk Inspection Partial 10/7/2020 10/7/2020 10/07/2020
Misc
Informational
10/05/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
10/05/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
10/05/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
10/05/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
10/05/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
10/05/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Sidewalk Inspection Partial 10/15/2020 10/15/2020 10/15/2020
Misc
Informational
10/07/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
10/07/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
10/07/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
10/07/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
10/07/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
10/07/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Misc
Informational
10/15/2020
JK Concrete formed and poured ADA ramp at the SW corner of Pryor and O’Brien. Randy Spalding removed old curbs and walks on the east side of Pryor and O’Brien. RP 10-15-20
Pavement-Curb Construction Partial 10/16/2020 10/16/2020 10/19/2020
Misc
Informational
09/15/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
09/15/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
09/15/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
09/15/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
09/15/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
09/15/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
09/15/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
09/15/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
09/15/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Misc
Informational
09/15/2020
They formed and poured the final 6 curb inlets on O’Brien, Ambersham and Killarney. RP 7-16-20
Misc
Informational
09/15/2020
After a curb proofroll was passed JK concrete came out and poured curbs with the curb machine on Ashurst and Kayela Ct. The testing company was on site and will send the results to Redford along with the receipt tickets for the KCMMB Concrete mix. They will then forward these on to Ron. I am going to give this a partial until we receive all the paperwork and test results.
Misc
Informational
09/15/2020
Brad’s crew from JK Concrete formed and poured curbs on the west side of Pryor and O’Brien. They still need to remove and replace curbs on the east side of the intersection. RP 9-15-20
Misc
Informational
10/16/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Misc
Informational
10/16/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Misc
Informational
10/16/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Sidewalk Inspection Partial 10/16/2020 10/16/2020 10/19/2020
Misc
Informational
10/15/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
10/15/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
10/15/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
10/15/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
10/15/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
10/15/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Misc
Informational
10/15/2020
JK Concrete formed and poured ADA ramp at the SW corner of Pryor and O’Brien. Randy Spalding removed old curbs and walks on the east side of Pryor and O’Brien. RP 10-15-20
Misc
Informational
10/19/2020
JK Concrete formed and poured ADA ramps and sidewalks on the east side of Pryor and O’Brien. RP 10-16-20
Site Visit Partial 10/19/2020 10/19/2020 10/19/2020
Misc
Informational
09/29/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
09/29/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
09/29/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
09/29/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
09/29/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
10/19/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Install Street and Stop Signs Partial 10/20/2020 10/20/2020 10/20/2020
Misc
Informational
10/20/2020
Stop signs have been installed at all locations. All street signs have been installed except for Killarney on one sign post. RP 10-20-20
Site Visit Partial 10/20/2020 10/20/2020 10/20/2020
Misc
Informational
10/19/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
10/19/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
10/19/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
10/19/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
10/19/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
10/19/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
10/20/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Install Street and Stop Signs Partial 10/22/2020 10/22/2020 10/23/2020
Misc
Informational
10/20/2020
Stop signs have been installed at all locations. All street signs have been installed except for Killarney on one sign post. RP 10-20-20
Misc
Corrective Action Required
10/23/2020
K&G Striping added the missing Killarney sign. They also aligned the street signs in the correct order on all street except Shamrock signs. They started to place stop bar and crosswalk at Ambersham instead of Ashurst. They painted the white turn lane line, but the roadway was too dirty to paint the double yellow lines on O’Brien. Thomas from Redford was going to see what needed to happen for them to paint the lines. RP 10-22-20
Site Visit Partial 11/2/2020 11/2/2020 11/02/2020
Misc
Informational
10/20/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
10/20/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
10/20/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
10/20/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
10/20/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
10/20/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
10/20/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
11/02/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Install Street and Stop Signs Partial 11/2/2020 11/2/2020 11/02/2020
Misc
Informational
10/23/2020
Stop signs have been installed at all locations. All street signs have been installed except for Killarney on one sign post. RP 10-20-20
Misc
Corrective Action Required
10/23/2020
K&G Striping added the missing Killarney sign. They also aligned the street signs in the correct order on all street except Shamrock signs. They started to place stop bar and crosswalk at Ambersham instead of Ashurst. They painted the white turn lane line, but the roadway was too dirty to paint the double yellow lines on O’Brien. Thomas from Redford was going to see what needed to happen for them to paint the lines. RP 10-22-20
Misc
Informational
11/02/2020
K&G Striping added the double yellow line to O’Brien. They also corrected the signage on Shamrock. Someone still needs to repair the stop sign on Ambersham. RP 11-2-20
Water - Material Verification Passed 9/15/2020 11/06/2020
Site Visit Partial 11/16/2020 11/16/2020 11/16/2020
Misc
Informational
11/02/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
11/02/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
11/02/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
11/02/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
11/02/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
11/02/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
11/02/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
11/02/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
11/16/2020
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Site Visit Partial 11/24/2020 11/24/2020 11/24/2020
Misc
Informational
11/16/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
11/16/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
11/16/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
11/16/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
11/16/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
11/16/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
11/16/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
11/16/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
11/16/2020
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
11/24/2020
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Site Visit Partial 12/1/2020 12/1/2020 12/01/2020
Misc
Informational
11/24/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
11/24/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
11/24/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
11/24/2020

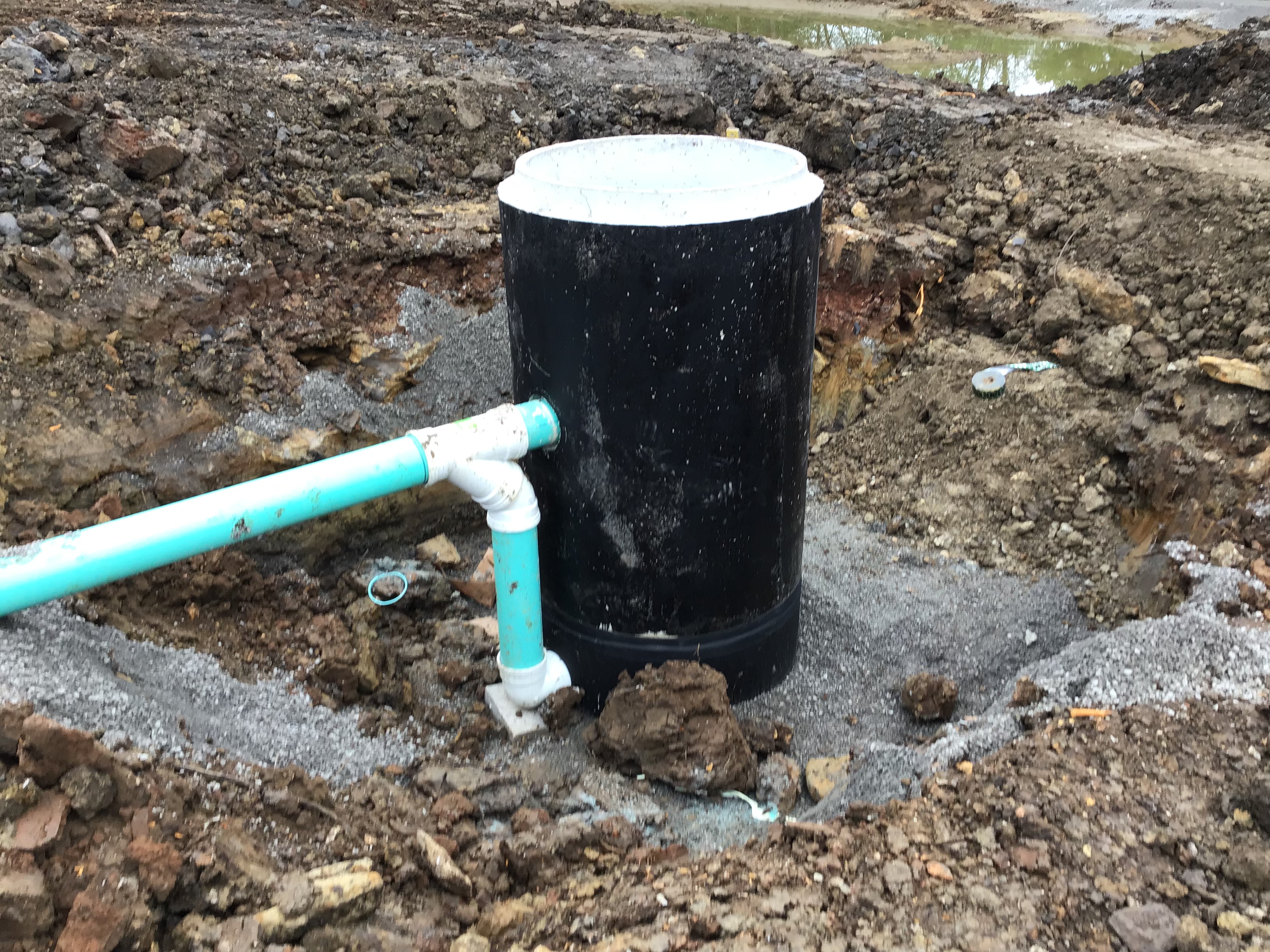

The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
11/24/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
11/24/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
11/24/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
11/24/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
11/24/2020
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
11/24/2020
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
12/01/2020
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Sidewalk Inspection Partial 12/10/2020 12/10/2020 12/10/2020
Misc
Informational
10/19/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
10/19/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
10/19/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
10/19/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
10/19/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
10/19/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Misc
Informational
10/19/2020
JK Concrete formed and poured ADA ramp at the SW corner of Pryor and O’Brien. Randy Spalding removed old curbs and walks on the east side of Pryor and O’Brien. RP 10-15-20
Misc
Informational
10/19/2020
JK Concrete formed and poured ADA ramps and sidewalks on the east side of Pryor and O’Brien. RP 10-16-20
Misc
Informational
12/10/2020
Ray Cochran replaced a section of walkway by Ashurst that the gas guys damaged. Forms were placed and aggregate was present and compacted. RP 12-10-20-
Site Visit Partial 12/10/2020 12/10/2020 12/11/2020
Misc
Informational
12/01/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
12/01/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
12/01/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
12/01/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
12/01/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
12/01/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
12/01/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
12/01/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
12/01/2020
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
12/01/2020
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
12/01/2020
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Sidewalk Inspection Partial 12/18/2020 12/18/2020 12/18/2020
Misc
Informational
12/10/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
12/10/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
12/10/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
12/10/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
12/10/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
12/10/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Misc
Informational
12/10/2020
JK Concrete formed and poured ADA ramp at the SW corner of Pryor and O’Brien. Randy Spalding removed old curbs and walks on the east side of Pryor and O’Brien. RP 10-15-20
Misc
Informational
12/10/2020
JK Concrete formed and poured ADA ramps and sidewalks on the east side of Pryor and O’Brien. RP 10-16-20
Misc
Informational
12/10/2020
Ray Cochran replaced a section of walkway by Ashurst that the gas guys damaged. Forms were placed and aggregate was present and compacted. RP 12-10-20-
Misc
Informational
12/18/2020
Finished sidewalk by Ashurst and Pryor meets LS and ADA specs. RP 12-18-20
Record Drawing Review Passed 11/5/2020 12/21/2020
Pavement-Curb Construction Partial 1/14/2021 1/14/2021 01/14/2021
Misc
Informational
10/19/2020
Brad’s crew from JK Concrete poured 160 cubic yards of KCMMB mix for curbing on Shamrock, Grady and Joshua. Mike from Geiger and Caleb from KC Testing were also present for the pour. We were steady at 6.5 air and 1 inch slump during random testing. They still need to form and finish the curb inlets. RP 6-18-20
Misc
Informational
10/19/2020
Brad’s crew from JK Concrete is forming up curb inlets on Shamrock, Grady and Joshua. Due to the chance of weather, they fill be pouring on Monday. RP 6-19-20
Misc
Informational
10/19/2020
Brad’s crew from JK Concrete set and poured all curb inlets on Shamrock. Redford Construction still needs to set lids on Grady and Joshua before those last 3 boxes can be finished. The total distance for this section of curbing is 3,223 ft. RP 6-22-20
Misc
Informational
10/19/2020
Brad’s crew formed and poured the remaining curb inlets on Shamrock and Grady. RP 6-23-20
Misc
Informational
10/19/2020
Brad’s crew formed curbs on half of Ambersham. They stopped due to it being too hot. RP 7-7-20
Misc
Informational
10/19/2020
Brad’s crew finished up on the part of Ambersham that was ready along with some of O’Brien. The also formed and poured 1 curb inlet before it too hot to work again. RP 7-8-20
Misc
Informational
10/19/2020
Brad’s crew laid curbing on Killarney and Ambersham where it connects to the older section. They still have a small portion of Ambersham to finish along with all the curb inlets. RP 7-10-20
Misc
Informational
10/19/2020
Brad’s crew finished pouring curbing for O’Brien, Ambersham and Killarney. RP 7-13-20
Misc
Informational
10/19/2020
Brad’s crew poured all but the last 4 curb inlets for O’Brien, Ambersham and Killarney. RP 7-14-20
Misc
Informational
10/19/2020
They formed and poured the final 6 curb inlets on O’Brien, Ambersham and Killarney. RP 7-16-20
Misc
Informational
10/19/2020
After a curb proofroll was passed JK concrete came out and poured curbs with the curb machine on Ashurst and Kayela Ct. The testing company was on site and will send the results to Redford along with the receipt tickets for the KCMMB Concrete mix. They will then forward these on to Ron. I am going to give this a partial until we receive all the paperwork and test results.
Misc
Informational
10/19/2020
Brad’s crew from JK Concrete formed and poured curbs on the west side of Pryor and O’Brien. They still need to remove and replace curbs on the east side of the intersection. RP 9-15-20
Misc
Informational
10/19/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Misc
Informational
10/19/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Misc
Informational
10/19/2020
JK Concrete replaced the curbing on the east side of Pryor and O’Brien for the new ADA ramps. RP 10-16-20
Misc
Informational
01/14/2021
JK Concrete removed all broken sections of curbing. Forms were placed and aggregate was present and compacted. Rebar and expansion joints are in place. RP 1-14-21
Sidewalk Inspection Partial 1/14/2021 1/14/2021 01/14/2021
Misc
Informational
12/18/2020
Forms were placed and aggregate was present and compacted on Shamrock, Grady and Joshua. RP 6-25-20
Misc
Informational
12/18/2020
The finished sidewalks on Shamrock, Grady and Joshua meets LS and ADA specs. RP 7-2-20
Misc
Informational
12/18/2020
Forms were placed and aggregate was present and compacted. JK Concrete poured 400 feet of sidewalk on O’Brien, Ambersham and Killarney. There is still a small section left to pour, but Redford needs to lower manhole lids first. RP 8-4-20
Misc
Informational
12/18/2020
Sidewalks on Ambersham, Killarney and O’Brien meets LS and ADA specs. They still need to form and lay additional sidewalk on Ambersham now that Redford lowered the manhole lids. RP 8-17-20
Misc
Informational
12/18/2020
Forms were placed and aggregate was present and compacted. Brad’s crew from JK Concrete poured 110 ft of sidewalk on the north side of O’Brien. East of the driveway approach for the vacant lot. RP 9-23-20
Misc
Informational
12/18/2020
10-5-20 8:50am JK concrete are pouring sidewalk on the north side of the road. I spoke to the Forman and he knows to use a broom finish and white cure. 2:35pm The sidewalk has been poured on the north side and approximately 100’ on the south side. 10-7-20 9:11m JK Concrete is pouring on the south side of the road. They are setting up along Pryor. 12:41pm They have poured approximately 80’of walking path on Pryor. They are setting up the ADA now.
Misc
Informational
12/18/2020
JK Concrete formed and poured ADA ramp at the SW corner of Pryor and O’Brien. Randy Spalding removed old curbs and walks on the east side of Pryor and O’Brien. RP 10-15-20
Misc
Informational
12/18/2020
JK Concrete formed and poured ADA ramps and sidewalks on the east side of Pryor and O’Brien. RP 10-16-20
Misc
Informational
12/18/2020
Ray Cochran replaced a section of walkway by Ashurst that the gas guys damaged. Forms were placed and aggregate was present and compacted. RP 12-10-20-
Misc
Informational
12/18/2020
Finished sidewalk by Ashurst and Pryor meets LS and ADA specs. RP 12-18-20
Misc
Informational
01/14/2021
JK Concrete removed all broken panels of sidewalks. Forms were placed and aggregate was present and compacted. RP 1-14-21
ESC - (Vegetation/Ground Cover) Partial 4/30/2021 4/30/2021 04/30/2021
Misc
Informational
04/30/2021
Kaylea Ct appears to be the only area that still needs vegetation. RP 4-30-21
Site Visit Partial 4/30/2021 4/30/2021 04/30/2021
Misc
Informational
12/11/2020
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
12/11/2020
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
12/11/2020
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
12/11/2020
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
12/11/2020
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
12/11/2020
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
12/11/2020
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
12/11/2020
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
12/11/2020
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
12/11/2020
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
12/11/2020
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
12/11/2020
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
04/30/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Site Visit Failed 5/1/2021 5/1/2021 05/24/2021
Misc
Informational
04/30/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
04/30/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
04/30/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
04/30/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
04/30/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
04/30/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
04/30/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
04/30/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
04/30/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
04/30/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
04/30/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
04/30/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
04/30/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
04/30/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
04/30/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
05/24/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Site Visit Partial 6/9/2021 6/9/2021 06/09/2021
Misc
Informational
05/24/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
05/24/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
05/24/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
05/24/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
05/24/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
05/24/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
05/24/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
05/24/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
05/24/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
05/24/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
05/24/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
05/24/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
05/24/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
05/24/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
05/24/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
05/24/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
06/09/2021
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Site Visit Partial 7/22/2021 7/22/2021 07/22/2021
Misc
Informational
06/09/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
06/09/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
06/09/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
06/09/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
06/09/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
06/09/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
06/09/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
06/09/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
06/09/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
06/09/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
06/09/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
06/09/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
06/09/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
06/09/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
06/09/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
06/09/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
06/09/2021
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Misc
Informational
07/22/2021
JK Concrete replaced curbing at 2nd and 3rd sunken areas of roadway on Ambersham by Killarney. RP 7-22-21
Site Visit Partial 7/26/2021 7/26/2021 07/26/2021
Misc
Informational
07/22/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
07/22/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
07/22/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
07/22/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
07/22/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
07/22/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
07/22/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
07/22/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
07/22/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
07/22/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
07/22/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
07/22/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/22/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/22/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/22/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
07/22/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
07/22/2021
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Misc
Informational
07/22/2021
JK Concrete replaced curbing at 2nd and 3rd sunken areas of roadway on Ambersham by Killarney. RP 7-22-21
Misc
Informational
07/26/2021
JK Concrete replaced the ADA ramp at Ambersham and Killarney. Redford Construction back filled the 2nd and 3rd sink holes with 4K KCMMB mix. RP 7-26-21
Site Visit Failed 7/28/2021 7/28/2021 08/05/2021
Misc
Informational
07/26/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
07/26/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
07/26/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
07/26/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
07/26/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
07/26/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
07/26/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
07/26/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
07/26/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
07/26/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
07/26/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
07/26/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/26/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/26/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
07/26/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
07/26/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
07/26/2021
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Misc
Informational
07/26/2021
JK Concrete replaced curbing at 2nd and 3rd sunken areas of roadway on Ambersham by Killarney. RP 7-22-21
Misc
Informational
07/26/2021
JK Concrete replaced the ADA ramp at Ambersham and Killarney. Redford Construction back filled the 2nd and 3rd sink holes with 4K KCMMB mix. RP 7-26-21
Misc
Corrective Action Required
08/05/2021
Concrete was spilled and dried in the roadway at Ashurst and Kaylea. RP 8-5-21
Site Visit Partial 8/9/2021 8/9/2021 02/24/2022
Misc
Informational
08/05/2021
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
08/05/2021
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
08/05/2021
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
08/05/2021
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
08/05/2021
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
08/05/2021
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
08/05/2021
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
08/05/2021
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
08/05/2021
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
08/05/2021
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
08/05/2021
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
08/05/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
08/05/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
08/05/2021
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
08/05/2021
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
08/05/2021
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
08/05/2021
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Misc
Informational
08/05/2021
JK Concrete replaced curbing at 2nd and 3rd sunken areas of roadway on Ambersham by Killarney. RP 7-22-21
Misc
Informational
08/05/2021
JK Concrete replaced the ADA ramp at Ambersham and Killarney. Redford Construction back filled the 2nd and 3rd sink holes with 4K KCMMB mix. RP 7-26-21
Misc
Corrective Action Required
08/05/2021
Concrete was spilled and dried in the roadway at Ashurst and Kaylea. RP 8-5-21
Misc
Informational
02/24/2022
No work being done today due to the snow. RP 2-24-22
Erosion Control Inspection Partial 03/23/2022
Misc
Corrective Action Required
03/23/2022
Talked with Summit Homes about some curb inlets that were filling up with silt. They told me they have been working with Gordon about their erosion control, but not happy with their service lately. He also told me he will contact them again about keeping the area cleaner. RP 3-23-22
Erosion Control Inspection Partial 03/24/2022
Misc
Corrective Action Required
03/23/2022
Talked with Summit Homes about some curb inlets that were filling up with silt. They told me they have been working with Gordon about their erosion control, but not happy with their service lately. He also told me he will contact them again about keeping the area cleaner. RP 3-23-22
Misc
Informational
03/24/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Site Visit Failed 05/24/2022
Misc
Informational
02/24/2022
Talked with Brian from Randy Spalding. They are re-grading the roadways on Shamrock, Grady and Joshua. Plan is to let them bake a couple more days before trying the proof-roll. RP 6-8-20
Misc
Informational
02/24/2022
Met Brad from JK Concrete on site. Answered questions concerning curb and sump inlets. RP 6-17-20
Misc
Informational
02/24/2022
Superior Bowen is attempting to clean the asphalt off of the concrete section of Shamrock. I will have Public Works check its status for approval on Monday. RP 8-1-20
Misc
Informational
02/24/2022
The Water Dept installed construction taps for the water main on Joshua and Ashurst. RP 9-25-20
Misc
Informational
02/24/2022
Brian’s crew from Spalding has been grading the west side of Pryor and O’Brien for the sidewalk and ADA ramps. RP 9-29-20
Misc
Informational
02/24/2022
K & G Striping was on site laying out the new crosswalks for Pryor and O’Brien intersection. They will also be removing the old crosswalks. They installed new crosswalks, stop bars and turn lane arrows. RP 10-19-20
Misc
Informational
02/24/2022
Brett from K&G Striping was laying out street lanes on Pryor and O’Brien intersection. I had Nick Lightner from Public Works help me with this installation. RP 10-20-20
Misc
Informational
02/24/2022
Talked with Capital Electric, who was on site installing the last ped crossing signal. There is a old concrete base that still needs to be removed. Capital is going to find out if it was their old ped signal base. K&G Striping finished applying the double yellow lines on O’Brien. They also corrected the orientation of the street signs on Shamrock. RP 11-2-20
Misc
Informational
02/24/2022
Walking the subdivision, compiling items that need to repaired or corrected for the punch list. RP 11-16-20
Misc
Informational
02/24/2022
Redford crew out working on damaged stop sign and adjusting manholes. Teague Electric is still working on power installation and trying to keep the roadway clean. RP 11-24-20
Misc
Informational
02/24/2022
Met with Aree and Heath from Redford Construction concerning cleaning out storm end sections that have become buried. Heath found solid rock under the buried end section. Solid rock needs to be removed and replaced with rip rap. RP 12-1-20
Misc
Informational
02/24/2022
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
02/24/2022
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
02/24/2022
Checked on punch list items. Concrete work is all the is remaining from original punch list. RP 12-11-20
Misc
Informational
02/24/2022
Only items remaining from the punch list is vegetation for Kaylea Ct and maintenance of all erosion control devices. RP 4-30-21
Misc
Corrective Action Required
02/24/2022
Curb inlets are full of silt on Ambersham. Please clean out and replace gutter buddies. RP 5-24-21
Misc
Informational
02/24/2022
Redford Construction removed sunken asphalt and curbing at 1 of the 3 areas on Ambersham. The poured the curbing and all but 2 inches of the hole with KCMMB concrete. RP 6-9-21
Misc
Informational
02/24/2022
JK Concrete replaced curbing at 2nd and 3rd sunken areas of roadway on Ambersham by Killarney. RP 7-22-21
Misc
Informational
02/24/2022
JK Concrete replaced the ADA ramp at Ambersham and Killarney. Redford Construction back filled the 2nd and 3rd sink holes with 4K KCMMB mix. RP 7-26-21
Misc
Corrective Action Required
02/24/2022
Concrete was spilled and dried in the roadway at Ashurst and Kaylea. RP 8-5-21
Misc
Informational
02/24/2022
No work being done today due to the snow. RP 2-24-22
Misc
Corrective Action Required
05/24/2022
Roadway and curb in front of 202 NW Ambersham is sinking and has started to form a depression. Picture attached. 5/24/22 ES
Documents & Images
Date Uploaded File Type Document Name
06/14/2019 Receipt Receipt for transaction: 2019-003712
06/20/2019 Letter DE-Permit
07/02/2019 Signed Permit
07/26/2019 Letter DE-Daily Inspection Summary
07/26/2019 Letter DE-Daily Inspection Summary
07/30/2019 Letter DE-Daily Inspection Summary
08/02/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY
08/05/2019 Letter INSPECTION SUMMARY
08/06/2019 Letter INSPECTION SUMMARY
08/10/2019 Letter INSPECTION SUMMARY
08/14/2019 Letter INSPECTION SUMMARY
08/14/2019 Letter INSPECTION SUMMARY
08/21/2019 Letter INSPECTION SUMMARY
08/23/2019 manhole #2-1 drop
08/23/2019 Letter INSPECTION SUMMARY
08/26/2019 Letter INSPECTION SUMMARY
08/27/2019 Letter INSPECTION SUMMARY
08/28/2019 Letter INSPECTION SUMMARY
08/28/2019 Letter INSPECTION SUMMARY
09/26/2019 Letter INSPECTION SUMMARY
09/27/2019 Letter INSPECTION SUMMARY
10/01/2019 Letter INSPECTION SUMMARY
10/01/2019 Letter INSPECTION SUMMARY
10/18/2019 Letter INSPECTION SUMMARY
10/18/2019 Letter INSPECTION SUMMARY
10/22/2019 Letter INSPECTION SUMMARY
10/24/2019 Letter INSPECTION SUMMARY
10/24/2019 Letter INSPECTION SUMMARY
10/25/2019 Letter INSPECTION SUMMARY
10/25/2019 Letter INSPECTION SUMMARY
10/25/2019 Letter INSPECTION SUMMARY
10/25/2019 Letter INSPECTION SUMMARY
11/08/2019 Letter INSPECTION SUMMARY
11/08/2019 Plans Submittal Woodside Ridge 1st Traffic Signal
11/27/2019 Letter INSPECTION SUMMARY
11/27/2019 Letter INSPECTION SUMMARY
12/04/2019 Letter INSPECTION SUMMARY
12/04/2019 Letter INSPECTION SUMMARY
12/27/2019 Letter INSPECTION SUMMARY
01/07/2020 Letter INSPECTION SUMMARY
01/07/2020 Letter INSPECTION SUMMARY
01/07/2020 Letter INSPECTION SUMMARY
01/29/2020 Letter INSPECTION SUMMARY
02/07/2020 Letter INSPECTION SUMMARY
02/07/2020 Letter INSPECTION SUMMARY
02/11/2020 Letter INSPECTION SUMMARY
02/11/2020 Letter INSPECTION SUMMARY
02/11/2020 Letter INSPECTION SUMMARY
02/19/2020 Letter INSPECTION SUMMARY
02/27/2020 Letter INSPECTION SUMMARY
02/27/2020 Letter INSPECTION SUMMARY
02/27/2020 Letter INSPECTION SUMMARY
02/27/2020 Letter INSPECTION SUMMARY
02/28/2020 Letter INSPECTION SUMMARY
02/28/2020 Letter INSPECTION SUMMARY
02/29/2020 Letter INSPECTION SUMMARY
03/02/2020 Letter INSPECTION SUMMARY
03/02/2020 Receipt Receipt for transaction: 2020-000922
03/03/2020 Letter INSPECTION SUMMARY
03/03/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/30/2020 Email Fwd Woodside Ridge Water Connection Line 9
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
04/03/2020 Letter INSPECTION SUMMARY
04/03/2020 Letter INSPECTION SUMMARY
04/09/2020 Letter INSPECTION SUMMARY
04/09/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/16/2020 Letter INSPECTION SUMMARY
04/16/2020 Letter INSPECTION SUMMARY
04/16/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
04/27/2020 Letter INSPECTION SUMMARY
04/29/2020 Letter INSPECTION SUMMARY
04/30/2020 Letter INSPECTION SUMMARY
04/30/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/04/2020 Letter INSPECTION SUMMARY
05/04/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/08/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
05/29/2020 Letter INSPECTION SUMMARY
06/02/2020 Letter INSPECTION SUMMARY
06/03/2020 Letter INSPECTION SUMMARY
06/04/2020 Letter INSPECTION SUMMARY
06/08/2020 Letter INSPECTION SUMMARY
06/10/2020 Letter INSPECTION SUMMARY
06/11/2020 Letter INSPECTION SUMMARY
06/12/2020 Letter INSPECTION SUMMARY
06/16/2020 WoodSide Ridge Sanitary Sewer Only Partial Substantial Completion
06/16/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
06/16/2020 Letter INSPECTION SUMMARY
06/16/2020 Letter INSPECTION SUMMARY
06/17/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter INSPECTION SUMMARY
06/19/2020 Letter INSPECTION SUMMARY
06/22/2020 Letter INSPECTION SUMMARY
06/24/2020 Letter INSPECTION SUMMARY
06/24/2020 Letter INSPECTION SUMMARY
06/25/2020 Letter INSPECTION SUMMARY
06/25/2020 Letter INSPECTION SUMMARY
06/26/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/08/2020 Letter INSPECTION SUMMARY
07/08/2020 Letter INSPECTION SUMMARY
07/10/2020 Letter INSPECTION SUMMARY
07/13/2020 Letter INSPECTION SUMMARY
07/14/2020 Letter INSPECTION SUMMARY
07/16/2020 Letter INSPECTION SUMMARY
07/17/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter INSPECTION SUMMARY
07/24/2020 Letter INSPECTION SUMMARY
07/25/2020 Letter INSPECTION SUMMARY
07/28/2020 Letter INSPECTION SUMMARY
07/30/2020 Letter INSPECTION SUMMARY
07/31/2020 Letter INSPECTION SUMMARY
08/01/2020 Letter INSPECTION SUMMARY
08/03/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/14/2020 Letter INSPECTION SUMMARY
08/18/2020 Letter INSPECTION SUMMARY
08/18/2020 Letter INSPECTION SUMMARY
08/18/2020 Letter INSPECTION SUMMARY
08/18/2020 Letter INSPECTION SUMMARY
08/19/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter DE-Daily Inspection Summary
08/26/2020 Letter DE-Daily Inspection Summary
08/26/2020 Letter DE-Daily Inspection Summary
08/28/2020 Letter INSPECTION SUMMARY
08/31/2020 Letter DE-Daily Inspection Summary
08/31/2020 Letter DE-Daily Inspection Summary
08/31/2020 Letter DE-Daily Inspection Summary
08/31/2020 Letter DE-Daily Inspection Summary
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter DE-Daily Inspection Summary
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/02/2020 Letter INSPECTION SUMMARY
09/03/2020 Letter INSPECTION SUMMARY
09/04/2020 Letter INSPECTION SUMMARY
09/15/2020 Letter INSPECTION SUMMARY
09/15/2020 Letter INSPECTION SUMMARY
09/15/2020 Letter INSPECTION SUMMARY
09/16/2020 Letter INSPECTION SUMMARY
09/18/2020 Letter INSPECTION SUMMARY
09/18/2020 Letter INSPECTION SUMMARY
09/21/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/28/2020 Letter INSPECTION SUMMARY
09/28/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/30/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/02/2020 Letter INSPECTION SUMMARY
10/02/2020 Letter INSPECTION SUMMARY
10/07/2020 Letter INSPECTION SUMMARY
10/07/2020 Letter INSPECTION SUMMARY
10/15/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/20/2020 Letter INSPECTION SUMMARY
10/20/2020 Letter INSPECTION SUMMARY
10/23/2020 Letter INSPECTION SUMMARY
11/02/2020 Plans 2020_11_01_Street and Storm Plans_As-built
11/02/2020 Plans 2020_11_01 Sanitary Sewer Asbuilt Plans
11/02/2020 Plans 2020_10_28 Water Main Extension AsBuilts
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/16/2020 Approved Plans Woodside Ridge - Spillway Plans Rev1 Approved 11.16.20
11/16/2020 Letter INSPECTION SUMMARY
11/16/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
11/18/2020 Letter DE-Punch List
11/18/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/24/2020 Letter INSPECTION SUMMARY
12/01/2020 Letter INSPECTION SUMMARY
12/02/2020 Plans 2020_12_02_Street and Storm Plans_As-built
12/10/2020 Letter INSPECTION SUMMARY
12/11/2020 Letter INSPECTION SUMMARY
12/11/2020 Plans 2020_12_11_Street and Storm Plans_As-built
12/17/2020 Plans 2020_12_17_Woodside Ridge - Spillway Plans
12/18/2020 Letter DE-Punch List
12/18/2020 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
01/15/2021 Plans Woodside Ridge 1st Plat Substantial Completion
01/26/2021 Security Document Woodside Ridge Maintenance Bond 1st Plat
02/15/2021 Plans 2021_02_12_WoodsideRidge1st_MasterDrainagePlan
04/30/2021 Letter INSPECTION SUMMARY
04/30/2021 Letter INSPECTION SUMMARY
04/30/2021 Letter INSPECTION SUMMARY
05/24/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
07/22/2021 Letter INSPECTION SUMMARY
07/26/2021 Letter INSPECTION SUMMARY
08/05/2021 Letter INSPECTION SUMMARY
02/24/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
03/24/2022 Letter INSPECTION SUMMARY
05/24/2022 Letter INSPECTION SUMMARY
05/24/2022 Photograph curb failure
12/06/2022 Engineer Report/Study 19-05-16_WTRS_SecondRevision_Woodside_Ridge_FinalMacro_and_FirstPlat
02/16/2023 Activity Document Woodside Ridge 1st Final Affidavit
10/09/2023 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
