Permit Application Status

PRCOM20204900


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20204900
Building Permit - Commercial
Certificate of Occupancy
OAK VIEW LEES SUMMIT LLC
NEW COMMERCIAL
NEW FAST FOOD RESTAURANT WITH DRIVE-THRU
12/23/2020
04/26/2021
06/28/2021
07/21/2022
Locations
Contacts
PINNACLE CONSTRUCTION, INC, Address:22060 221ST SOUTH, Phone:(712) 527-9745
TAYLOR MECHANICAL INC, Address:23700 E 189th st, Phone:(816) 743-9900
PHAZE ONE ELECTRIC, Address:807 E NORTHVIEW , Phone:(913) 208-5927
TEMP-CON LLC, Address:15670 S KEELER ST, Phone:(913) 768-4888
MS CONSULTANTS INC, Address:2221 SCHROCK RD, Phone:(614) 898-7100
OAK VIEW LEES SUMMIT LLC, Address:201 HAWKS RIDGE TRL
GREG TORRY, Address:GregT@pinconstr.com, Phone:(318) 451-8146
Reviews
Review Type Outcome Est. Completion Date Completed
Alarm Plan Review Released for Construction 08/17/2021 08/17/2021
Michael Weissenbach
Installation acceptance testing
Corrective Action Required
08/17/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Misc
Resolved
08/17/2021

(Action Required) 1. Strobes only in the bathrooms 2. Clarification on why the weatherproof horn/strobes are in the freezer and cooler area.
Alarm Plan Review Rejected 07/23/2021 07/23/2021
Michael Weissenbach
Installation acceptance testing
Corrective Action Required
07/23/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Misc
Corrective Action Required
07/23/2021

(Action Required) 1. Strobes only in the bathrooms 2. Clarification on why the weatherproof horn/strobes are in the freezer and cooler area.
Sprinkler Plan Review Released for Construction 07/07/2021 07/07/2021
Michael Weissenbach
Installation acceptance testing
Corrective Action Required
07/07/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule a hydrostatic test and a water flow test.
Licensed Contractors Approved 02/04/2021 04/13/2021
Joe Frogge
LC - General Contractor
Resolved
04/13/2021

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact. 1/29/21 - Acknowledged in letter.
LC - MEP Subs
Resolved
04/13/2021

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 1/29/21 - Acknowledged in letter.
r
Building Plan Review Approved with Conditions 02/04/2021 04/13/2021
Joe Frogge
Misc
Resolved
04/13/2021

A License Tax application completed by the contractor must be submitted to the City of Lee's Summit, Codes Administration Department, and any applicable License Tax paid prior to issuing a building permit. Action required: Comment is for informational purposes. 1/29/21 - Acknowledged in letter.
Final Development Plan
Resolved
04/13/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 1/29/21 - Acknowledged in letter.
Health Dept Review
Resolved
02/02/2021

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes. 1/29/21 - Acknowledged in letter.
Health Dept Inspection
Corrective Action Required
01/28/2021

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 1/29/21 - Acknowledged in letter.
Engineered truss package
Corrective Action Required
01/28/2021

Copies of the engineered truss package were not provided at the time of permit application. Action required: Comment is for informational purposes. Roof truss package deferred per request. Inspections will not be performed prior to approval of truss designs. 1/29/21 - Deferred per request.
IBC 1015.6 Mechanical equipment, systems and devices - hvac within 10 feet of roof edge
Resolved
01/29/2021

2018 IBC 1015.6 Mechanical equipment, systems and devices. Guards shall be provided where various components that require service are located within 10 feet of a roof edge or open side of a walking surface and such edge or open side is located more than 30 inches above the floor, roof or grade below. The guard shall extend not less than 30 inches beyond each end of such components. The guard shall be constructed so as to prevent the passage of a sphere 21 inches in diameter. Action required: Provide minimum 42" tall guards at roof edge near refrigerant system condensing units.
Planning - Screening of rooftop equipment
Corrective Action Required
01/28/2021

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: All roof equipment to be screened including exhaust fans and refrigerant system condensing units. 1/29/21 - per architect, parapet is sufficient to screen equipment. To be field verified.
IMC 507.2.6 Clearances for Type I hood
Resolved
01/29/2021

2018 IMC 507.2.6 Clearances for Type I hood. A Type I hood shall be installed with a clearance to combustibles of not less than 18”. Exceptions: 1. Clearance shall not be required from gypsum wallboard or ½ inch or thicker cementitious wallboard attached to noncombustible structures provided that a smooth, cleanable, nonabsorbent and noncombustible material is installed between the hood and the gypsum or cementitious wallboard over an area extending not less than 18 inches in all directions from the hood. 2. Type I hoods listed and labeled for clearances less than 18 inches in accordance with UL 710 shall be installed with the clearances specified by such listings. Action required: Type 1 Hoods not allowed to be installed within 18" of combustible surfaces. 1/29/21 - see NFPA letter
IMC 306.5 Equipment on roofs
Resolved
01/29/2021

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide side rail extender at roof hatch ladder.
ICC A117.1 604.5.1 Fixed side wall grab bars
Resolved
01/29/2021

ICC A117.1 604.5.1 Fixed side wall grab bars. Fixed side-wall grab bars shall include a horizontal bar complying with Section 604.5.1.1 and a vertical grab bar complying with Section 604.5.12. The vertical grab bar at water closets primarily for children’s use shall comply with Section 609.4.2. ICC A117.1 604.5.1.1 Horizontal grab bar. A horizontal grab bar 42 inches minimum in length shall be located 12 inches maximum from the rear wall and extending 54 inches minimum from the rear wall. ICC A117.1 604.5.1.2 Vertical grab bar. A vertical grab bar 18 inches minimum in length shall be mounted with the bottom of the bar located 39 inches minimum and 41 inches maximum above the floor, and with the center line of the bar located 39 inches minimum and 41 inches maximum from the rear wall. Action required: Provide vertical side grab bar at accessible toilets.
Gen - Plan submittals 2018 codes
Resolved
01/29/2021

All plans submitted for review on or after April 1, 2019 shall be designed to the requirements of the 2018 International Building Code, 2018 International Mechanical Code, 2018 International Plumbing Code, 2018 International Fuel Gas Code, 2018 International Fire Code, 2017 National Electric Code and the ICC/ANSI A117.1-2009 as amended and adopted by the City of Lee’s Summit. Action required: Update incorrect code reference on S0.2.
Miscellaneous Correction
Resolved
01/29/2021

Inadequate information to complete review. Provide the following: - Pipe material schedule including, but not limited to, water, DWV, NG. - Specify location of pressure reducing valve. (PRV required in all building domestic water services)
IPC 1003.3.1 Grease interceptors
Resolved
01/29/2021

2018 IPC 1003.3.1 Grease interceptors and automatic grease removal devices required. A grease interceptor or automatic grease removal device shall be required to receive the drainage from fixtures and equipment with grease-laden waste located in food preparation areas, such as in restaurants, hotel kitchens, hospitals, school kitchens, bars, factory cafeterias and clubs. Fixtures and equipment shall include pot sinks, pre-rinse sinks; soup kettles or similar devices; work stations; floor drains or sinks into which kettles are drained; automatic hood wash units and dishwashers without pre-rinse sinks. Grease interceptors and automatic grease removal devices shall receive waste only from fixtures and equipment that allow fats, oils or grease to be discharged. Where lack of space or other constraints prevent the installation or replacement of a grease interceptor, one or more grease interceptors shall be permitted to be installed on or above the floor and upstream of an existing grease interceptor. Action required: Hand sink near drive-thru not allowed to be connected to grease waste.
IBC 1008.3 Emergency power for illumination - at exit discharge
Resolved
01/29/2021

2018 IBC 1008.3 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises’ electrical supply. 1008.3.1 General. In the event of power supply failure in rooms and spaces that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Aisles. 2. Corridors. 3. Exit access stairways and ramps. 1008.3.2 Buildings. In the event of power supply failure in buildings that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Interior exit access stairways and ramps. 2. Interior and exterior exit stairways and ramps. 3. Exit passageways. 4. Vestibules and areas on the level of discharge used for exit discharge in accordance with Section 1028.1. 5. Exterior landings as required by Section 1010.1.6 for exit doorways that lead directly to the exit discharge. 1008.3.3 Rooms and Spaces. In the event of power supply failure an emergency electrical system shall automatically illuminate all of the following areas: 1. Electrical equipment rooms. 2. Fire command centers. 3. Fire pump rooms. 4. Generator rooms. 5. Public restrooms with an area greater than 300 square feet. Action required: Provide emergency lighting at exterior side of exits.
NEC Article 110.26 Spaces about electrical equipment
Corrective Action Required
01/28/2021

2017 NEC Article 110.26 Spaces About Electrical Equipment. Access and working space shall be provided and maintained about all electrical equipment to permit ready and safe operation and maintenance of such equipment. (see code for details) Action required: Comment is for informational purposes. Minimum clearances in front of panels must be maintained. To be field verified. (shown compliant on A-series, but not on E-series) 1/29/21 - Acknowledged in letter.
Health Department Review Approved 02/02/2021
Joe Frogge
Fire Plan Review Approved with Conditions 02/04/2021 01/28/2021
Michael Weissenbach
Posting of occupant load
Resolved
01/28/2021

2018 IFC 1004.3- Posting of occupant load. Every room or space that is an assembly occupancy shall have the occupant load of the room or space posted in a conspicuous place, near the main exit or exit access doorway from the room or space. Posted signs shall be of an approved legible permanent design and shall be maintained by the owner or authorized agent. (Verified At Inspection) Post occupant load signage at 101.
Construction documents for fire alarm systems
Corrective Action Required
01/28/2021

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. (Action Required) Provide PE stamped electronic shop drawings for the fire alarm system to mike.weissenbach@cityofls.net
Address numbers required
Resolved
01/28/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Corrective Action Required
01/28/2021

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Verified At Inspection) Order a Knox Box from knoxbox.com. Placement to be made by FDC.
Type I hood - Where required
Resolved
01/28/2021

2018 IFC 609.2- Where required. A Type I hood shall be installed at or above all commercial cooking appliances and domestic cooking appliances used for commercial purposes that produce grease vapors. (Action Required) Provide specs on Type 1 Hood and placement of manual pull. K-Class extinguisher to be hung under the pull if possible.
Construction documents - Fire protection systems
Corrective Action Required
01/28/2021

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. (Action Required) Provide PE stamped electronic shop drawings for the fire sprinkler system to mike.weissenbach@cityofls.net
Installation acceptance testing
Corrective Action Required
01/28/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Miscellaneous Correction
Resolved
01/28/2021

(Action Required) Provide specs on CO2 tank and gas detection. Tank over 100 pounds will require gas detection. 2018 IFC 5307.3
Illumination required
Resolved
01/28/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required) Provide exterior emergency lighting at the exit doors.
Building Plan Review Rejected 01/11/2021 12/29/2020
Joe Frogge
Misc
Corrective Action Required
12/29/2020

A License Tax application completed by the contractor must be submitted to the City of Lee's Summit, Codes Administration Department, and any applicable License Tax paid prior to issuing a building permit. Action required: Comment is for informational purposes.
Final Development Plan
Corrective Action Required
12/29/2020

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
Health Dept Review
Corrective Action Required
12/29/2020

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes.
Health Dept Inspection
Corrective Action Required
12/29/2020

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes.
Engineered truss package
Corrective Action Required
12/29/2020

Copies of the engineered truss package were not provided at the time of permit application. Action required: Comment is for informational purposes. Roof truss package deferred per request. Inspections will not be performed prior to approval of truss designs.
IBC 1015.6 Mechanical equipment, systems and devices - hvac within 10 feet of roof edge
Corrective Action Required
12/29/2020

2018 IBC 1015.6 Mechanical equipment, systems and devices. Guards shall be provided where various components that require service are located within 10 feet of a roof edge or open side of a walking surface and such edge or open side is located more than 30 inches above the floor, roof or grade below. The guard shall extend not less than 30 inches beyond each end of such components. The guard shall be constructed so as to prevent the passage of a sphere 21 inches in diameter. Action required: Provide minimum 42" tall guards at roof edge near refrigerant system condensing units.
Planning - Screening of rooftop equipment
Corrective Action Required
12/29/2020

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: All roof equipment to be screened including exhaust fans and refrigerant system condensing units.
IMC 507.2.6 Clearances for Type I hood
Corrective Action Required
12/29/2020

2018 IMC 507.2.6 Clearances for Type I hood. A Type I hood shall be installed with a clearance to combustibles of not less than 18”. Exceptions: 1. Clearance shall not be required from gypsum wallboard or ½ inch or thicker cementitious wallboard attached to noncombustible structures provided that a smooth, cleanable, nonabsorbent and noncombustible material is installed between the hood and the gypsum or cementitious wallboard over an area extending not less than 18 inches in all directions from the hood. 2. Type I hoods listed and labeled for clearances less than 18 inches in accordance with UL 710 shall be installed with the clearances specified by such listings. Action required: Type 1 Hoods not allowed to be installed within 18" of combustible surfaces.
IMC 306.5 Equipment on roofs
Corrective Action Required
12/29/2020

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide side rail extender at roof hatch ladder.
ICC A117.1 604.5.1 Fixed side wall grab bars
Corrective Action Required
12/29/2020

ICC A117.1 604.5.1 Fixed side wall grab bars. Fixed side-wall grab bars shall include a horizontal bar complying with Section 604.5.1.1 and a vertical grab bar complying with Section 604.5.12. The vertical grab bar at water closets primarily for children’s use shall comply with Section 609.4.2. ICC A117.1 604.5.1.1 Horizontal grab bar. A horizontal grab bar 42 inches minimum in length shall be located 12 inches maximum from the rear wall and extending 54 inches minimum from the rear wall. ICC A117.1 604.5.1.2 Vertical grab bar. A vertical grab bar 18 inches minimum in length shall be mounted with the bottom of the bar located 39 inches minimum and 41 inches maximum above the floor, and with the center line of the bar located 39 inches minimum and 41 inches maximum from the rear wall. Action required: Provide vertical side grab bar at accessible toilets.
Gen - Plan submittals 2018 codes
Corrective Action Required
12/29/2020

All plans submitted for review on or after April 1, 2019 shall be designed to the requirements of the 2018 International Building Code, 2018 International Mechanical Code, 2018 International Plumbing Code, 2018 International Fuel Gas Code, 2018 International Fire Code, 2017 National Electric Code and the ICC/ANSI A117.1-2009 as amended and adopted by the City of Lee’s Summit. Action required: Update incorrect code reference on S0.2.
Miscellaneous Correction
Corrective Action Required
12/29/2020

Inadequate information to complete review. Provide the following: - Pipe material schedule including, but not limited to, water, DWV, NG. - Specify location of pressure reducing valve. (PRV required in all building domestic water services)
IPC 1003.3.1 Grease interceptors
Corrective Action Required
12/29/2020

2018 IPC 1003.3.1 Grease interceptors and automatic grease removal devices required. A grease interceptor or automatic grease removal device shall be required to receive the drainage from fixtures and equipment with grease-laden waste located in food preparation areas, such as in restaurants, hotel kitchens, hospitals, school kitchens, bars, factory cafeterias and clubs. Fixtures and equipment shall include pot sinks, pre-rinse sinks; soup kettles or similar devices; work stations; floor drains or sinks into which kettles are drained; automatic hood wash units and dishwashers without pre-rinse sinks. Grease interceptors and automatic grease removal devices shall receive waste only from fixtures and equipment that allow fats, oils or grease to be discharged. Where lack of space or other constraints prevent the installation or replacement of a grease interceptor, one or more grease interceptors shall be permitted to be installed on or above the floor and upstream of an existing grease interceptor. Action required: Hand sink near drive-thru not allowed to be connected to grease waste.
IBC 1008.3 Emergency power for illumination - at exit discharge
Corrective Action Required
12/29/2020

2018 IBC 1008.3 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises’ electrical supply. 1008.3.1 General. In the event of power supply failure in rooms and spaces that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Aisles. 2. Corridors. 3. Exit access stairways and ramps. 1008.3.2 Buildings. In the event of power supply failure in buildings that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Interior exit access stairways and ramps. 2. Interior and exterior exit stairways and ramps. 3. Exit passageways. 4. Vestibules and areas on the level of discharge used for exit discharge in accordance with Section 1028.1. 5. Exterior landings as required by Section 1010.1.6 for exit doorways that lead directly to the exit discharge. 1008.3.3 Rooms and Spaces. In the event of power supply failure an emergency electrical system shall automatically illuminate all of the following areas: 1. Electrical equipment rooms. 2. Fire command centers. 3. Fire pump rooms. 4. Generator rooms. 5. Public restrooms with an area greater than 300 square feet. Action required: Provide emergency lighting at exterior side of exits.
NEC Article 110.26 Spaces about electrical equipment
Corrective Action Required
12/29/2020

2017 NEC Article 110.26 Spaces About Electrical Equipment. Access and working space shall be provided and maintained about all electrical equipment to permit ready and safe operation and maintenance of such equipment. (see code for details) Action required: Comment is for informational purposes. Minimum clearances in front of panels must be maintained. To be field verified. (shown compliant on A-series, but not on E-series)
Fire Plan Review Rejected 01/11/2021 12/29/2020
Michael Weissenbach
Posting of occupant load
Corrective Action Required
12/29/2020

2018 IFC 1004.3- Posting of occupant load. Every room or space that is an assembly occupancy shall have the occupant load of the room or space posted in a conspicuous place, near the main exit or exit access doorway from the room or space. Posted signs shall be of an approved legible permanent design and shall be maintained by the owner or authorized agent. (Verified At Inspection) Post occupant load signage at 101.
Construction documents for fire alarm systems
Corrective Action Required
12/29/2020

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. (Action Required) Provide PE stamped electronic shop drawings for the fire alarm system to mike.weissenbach@cityofls.net
Address numbers required
Corrective Action Required
12/29/2020

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Corrective Action Required
12/29/2020

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Action Required) Order a Knox Box from knoxbox.com. Placement to be made by FDC.
Type I hood - Where required
Corrective Action Required
12/29/2020

2018 IFC 609.2- Where required. A Type I hood shall be installed at or above all commercial cooking appliances and domestic cooking appliances used for commercial purposes that produce grease vapors. (Action Required) Provide specs on Type 1 Hood and placement of manual pull. K-Class extinguisher to be hung under the pull if possible.
Construction documents - Fire protection systems
Corrective Action Required
12/29/2020

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. (Action Required) Provide PE stamped electronic shop drawings for the fire sprinkler system to mike.weissenbach@cityofls.net
Installation acceptance testing
Corrective Action Required
12/29/2020

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Miscellaneous Correction
Corrective Action Required
12/29/2020

(Action Required) Provide specs on CO2 tank and gas detection. Tank over 100 pounds will require gas detection. 2018 IFC 5307.3
Illumination required
Corrective Action Required
12/29/2020

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required) Provide exterior emergency lighting at the exit doors.
Licensed Contractors Rejected 01/11/2021 12/29/2020
Joe Frogge
LC - General Contractor
Corrective Action Required
12/29/2020

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact.
LC - MEP Subs
Corrective Action Required
12/29/2020

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $7,400.00 $7,400.00 Paid 04/23/2021
8331507-Sewer Connection Fee $390.00 $390.00 Paid 04/23/2021
7232302-Commercial License Tax Fee $43,147.50 $43,147.50 Paid 04/23/2021
8331401-Water Tap Fee $21,486.00 $21,486.00 Paid 04/23/2021
9110071-Site Grading Fee $4,740.00 $4,740.00 Paid 04/23/2021
91100C9-Water Insp Fee $845.30 $845.30 Paid 04/23/2021
9110068-Storm Fee $847.08 $847.08 Paid 04/23/2021
9110081-Paved Surface Inspection Fee $4,838.46 $4,838.46 Paid 04/23/2021
8350015-Water Meter Fee $3,456.47 $3,456.47 Paid 04/23/2021
9110072-Water Test Fee $400.00 $400.00 Paid 04/23/2021
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 04/23/2021
91100C8-Sanitary Sewer Insp Fees $115.97 $115.97 Paid 04/23/2021
9110080-Not Ready Inspection Fee $50.00 $50.00 Paid 09/15/2021
9110080-Not Ready Inspection Fee $50.00 $50.00 Paid 11/11/2021
9110080-Not Ready Inspection Fee $50.00 $50.00 Paid 11/11/2021
9110069-After Hours Inspections (Public Works)(Per Hour) $650.00 $650.00 Paid 11/11/2021
9110069-After Hours Inspections (Public Works)(Per Hour) $400.00 $400.00 Paid 11/11/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

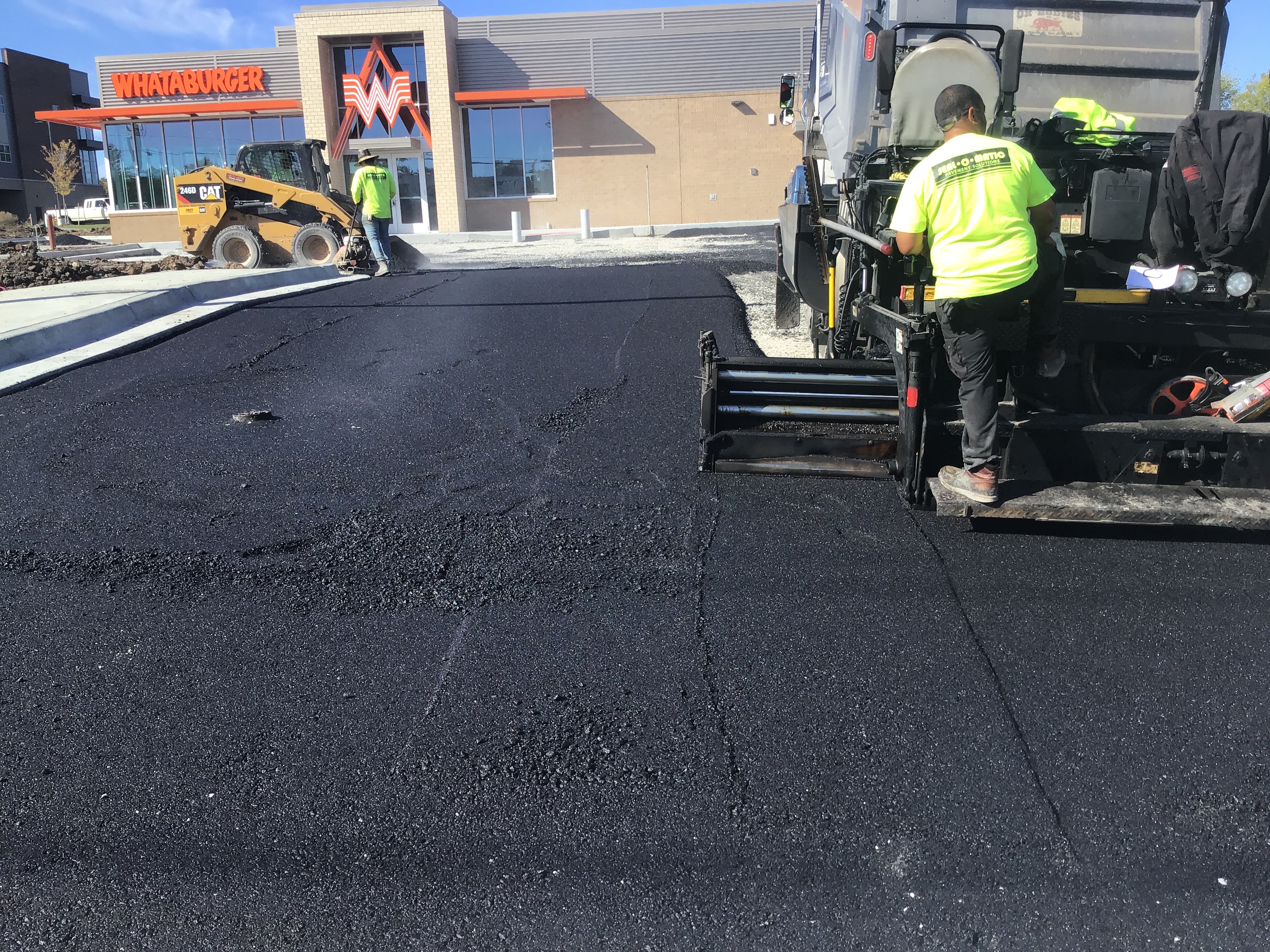

Footing Inspection - Commercial Passed 6/2/2021 (1:00) 6/2/2021 06/02/2021
Misc
Informational
06/02/2021
UFER LOCATED NE CORNER OF BLDG
Underslab Plumbing Inspection - Commercial Passed 6/9/2021 6/9/2021 06/09/2021
Site Visit Partial 6/14/2021 06/14/2021
Misc
Informational
06/11/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time.
Site Visit Partial 6/15/2021 06/15/2021
Misc
Informational
06/14/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time.
In-wall Inspection Partial 7/29/2021 7/29/2021 07/29/2021
Misc
Informational
07/29/2021
: THE FOLLOWING AREAS ARE APPROVED : - COOLER WALLS, ELECTRICAL PANEL WALL -
In-wall Inspection Failed 7/30/2021 7/30/2021 08/02/2021
Misc
Informational
07/29/2021
: THE FOLLOWING AREAS ARE APPROVED : - COOLER WALLS, ELECTRICAL PANEL WALL -
Misc
Corrective Action Required
07/30/2021
Seal upward penetrations ( fire caulk ) Provide mid point support vertical DWV 2" & smaller Boca plates plumbing Provide anchor bolts within 12" of plate break & end of plate Secure wall at cleaning room
Underground Electrical Inspection - Commercial Partial 8/3/2021 8/3/2021 08/03/2021
Misc
Informational
08/03/2021
- TRANSFORMER TO BLDG NORTH SIDE -
In-wall Inspection Partial 8/3/2021 8/3/2021 08/03/2021
Misc
Informational
07/30/2021
: THE FOLLOWING AREAS ARE APPROVED : - COOLER WALLS, ELECTRICAL PANEL WALL -
Misc
Corrective Action Required
07/30/2021
Seal upward penetrations ( fire caulk commercial grade no residential ) : OK TO INSULATE : - DO NOT COVER UNTIL REINSPECTION -
In-wall Inspection Passed 8/4/2021 8/4/2021 08/04/2021
Misc
Informational
08/03/2021
: THE FOLLOWING AREAS ARE APPROVED : - COOLER WALLS, ELECTRICAL PANEL WALL -
Misc
Informational
08/04/2021
Above Ceiling Inspection Partial 8/10/2021 8/10/2021 08/10/2021
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
08/10/2021
- HARD LIDS, RESTROOMS, POS AREA NORTH END -
Rough Framing Inspection - Commercial Passed 8/23/2021 8/23/2021 08/23/2021
Misc
Informational
08/23/2021
FIRE RATED PLYWOOD INSTALLED BEHIND KITCHEN HOOD EAST WALL
Underground Plumbing Inspection - Commercial Partial 8/27/2021 08/27/2021
Misc
Informational

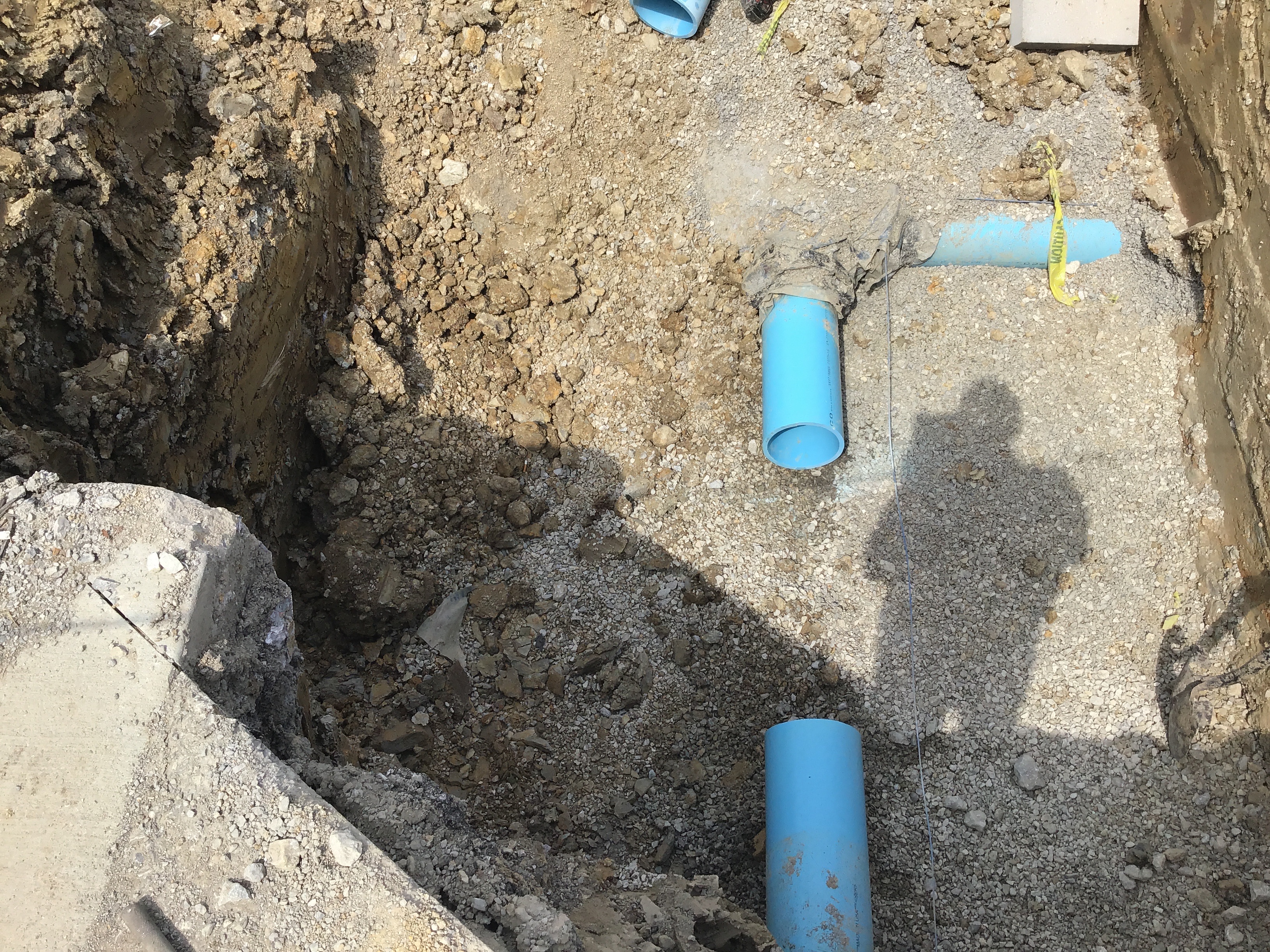

08/27/2021
- 17' GREASE & VENT LINE EXITING BUILDING WEST SIDE -
Underground Plumbing Inspection - Commercial Not Ready 9/8/2021 9/8/2021 09/08/2021
Misc
Informational
08/27/2021
- 17' GREASE & VENT LINE EXITING BUILDING WEST SIDE - - COMPLETE VENT LINES TO GREASE INTERCEPTER PER PLAN -
Underground Plumbing Inspection - Commercial Partial 9/9/2021 9/9/2021 09/09/2021
Misc
Informational
09/08/2021
- 17' GREASE & VENT LINE EXITING BUILDING WEST SIDE - - GREASE INTERCEPTOR WEST OF BLDG OK TO COVER -
Rough Electrical Inspection - Commercial Not Ready 9/15/2021 9/15/2021 09/15/2021
Electrical Service Inspection Passed 9/16/2021 09/16/2021

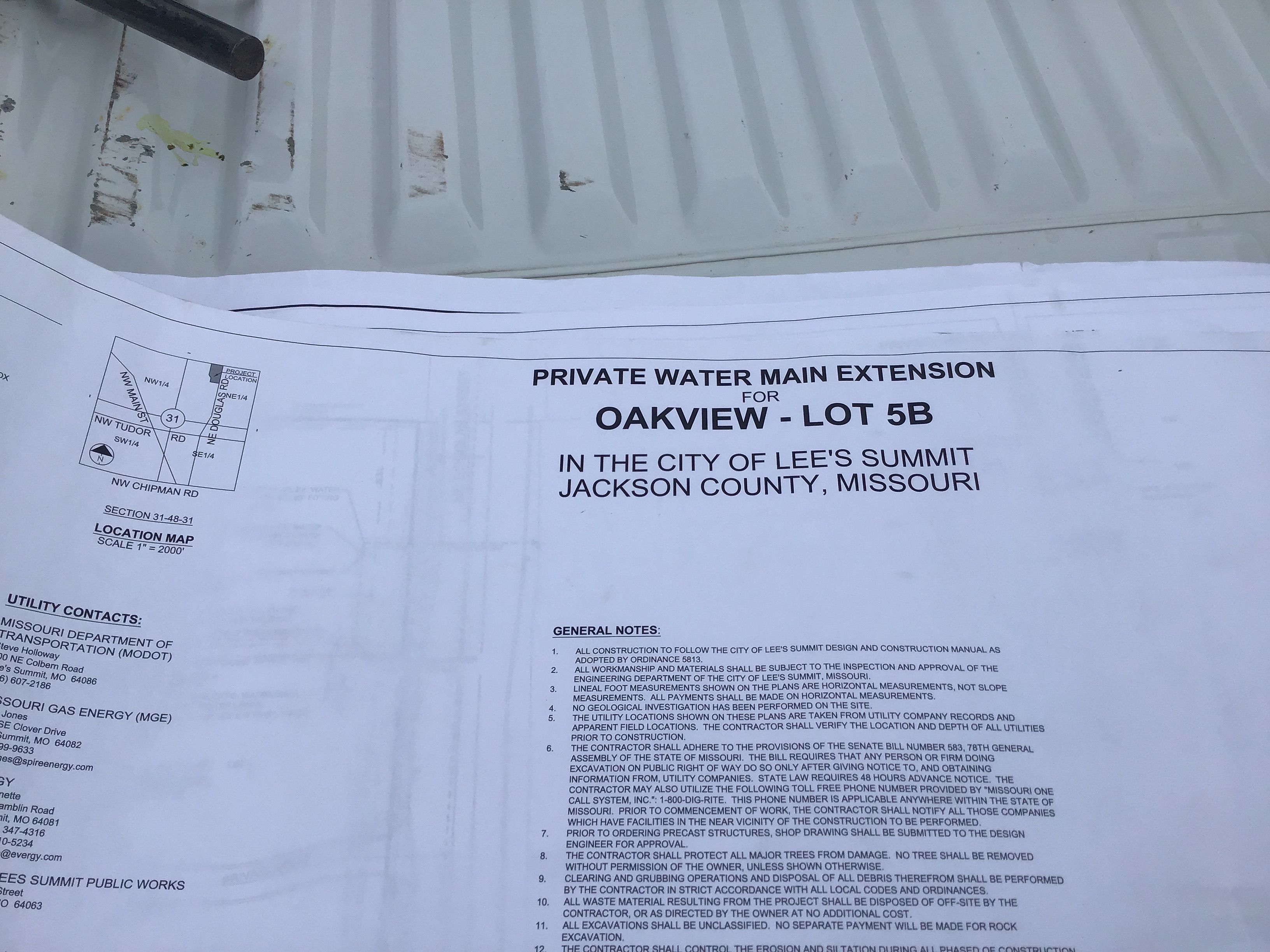

Fire Line Construction Inspection Passed 6/1/2021 6/1/2021 09/17/2021
Misc
Informational
06/01/2021
6-1-21 9:25am Breit is on site. They are setting up to install the fire line riser in the building.
Fire Line - Hydrostatic Test Passed 09/17/2021
Misc
Informational
09/17/2021
9/16/21 Thursday 6” Private Water Line extension was tested @ 200psi for 2hrs starting at 10:05AM to 12:05AM. 9/17/21 Friday Fire Line pass test @ 200psi for 2hrs starting @ 12:05AM to 2:05AM.
Hood/Duct Inspection Partial 9/21/2021 9/21/2021 09/21/2021
Misc
Corrective Action Required
09/21/2021
WELD LIGHT TEST 2 HOODS OK. APPROVED FOR 1ST LAYER TO BE INSTALLED. CALL WHEN REEADY
Hood/Duct Inspection Partial 9/22/2021 9/22/2021 09/22/2021
Misc
Corrective Action Required
09/21/2021
WELD LIGHT TEST 2 HOODS OK. APPROVED FOR 1ST LAYER TO BE INSTALLED. CALL WHEN READY 1ST LAYER APPROVED FOR 2ND LAYER OF WRAP
Hood/Duct Inspection Passed 9/23/2021 9/23/2021 09/23/2021
Misc
Corrective Action Required
09/22/2021
WELD LIGHT TEST 2 HOODS OK. APPROVED FOR 1ST LAYER TO BE INSTALLED. CALL WHEN READY 1ST LAYER APPROVED FOR 2ND LAYER OF WRAP 2ND LAYER WRAP APPROVED
Underground Electrical Inspection - Commercial Partial 9/23/2021 09/23/2021
Misc
Informational
08/03/2021
- THE FOLOWING ITEMS ARE APPROVED - - TRANSFORMER TO BLDG NORTH SIDE - - CONDUIT FOR LIGHT POLE BASES FRONT SIDE OF BLDG ONLY OK TO COVER -
Piers/Caissons Inspection - Commercial Partial 9/24/2021 (9:00) 9/24/2021 09/24/2021
Misc
Informational
09/24/2021
Light pole piers Ok to pour, except LP 1 and 2 not ready
Footing Inspection - Commercial Passed 9/29/2021 9/29/2021 09/29/2021
Misc
Informational

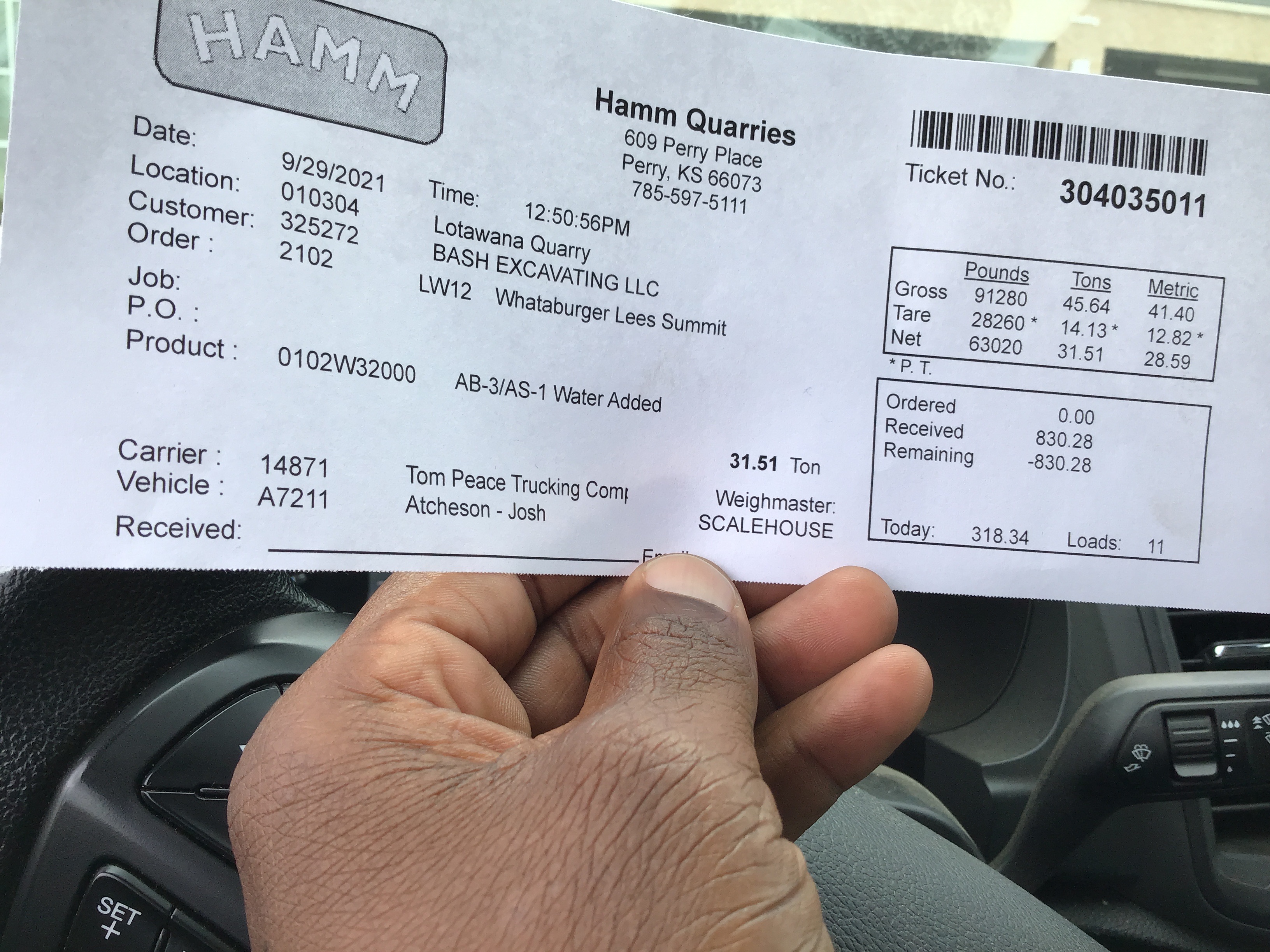

09/29/2021
FOOTING FOR TRASH ENCLOSURE PER PLAN OK TO POUR

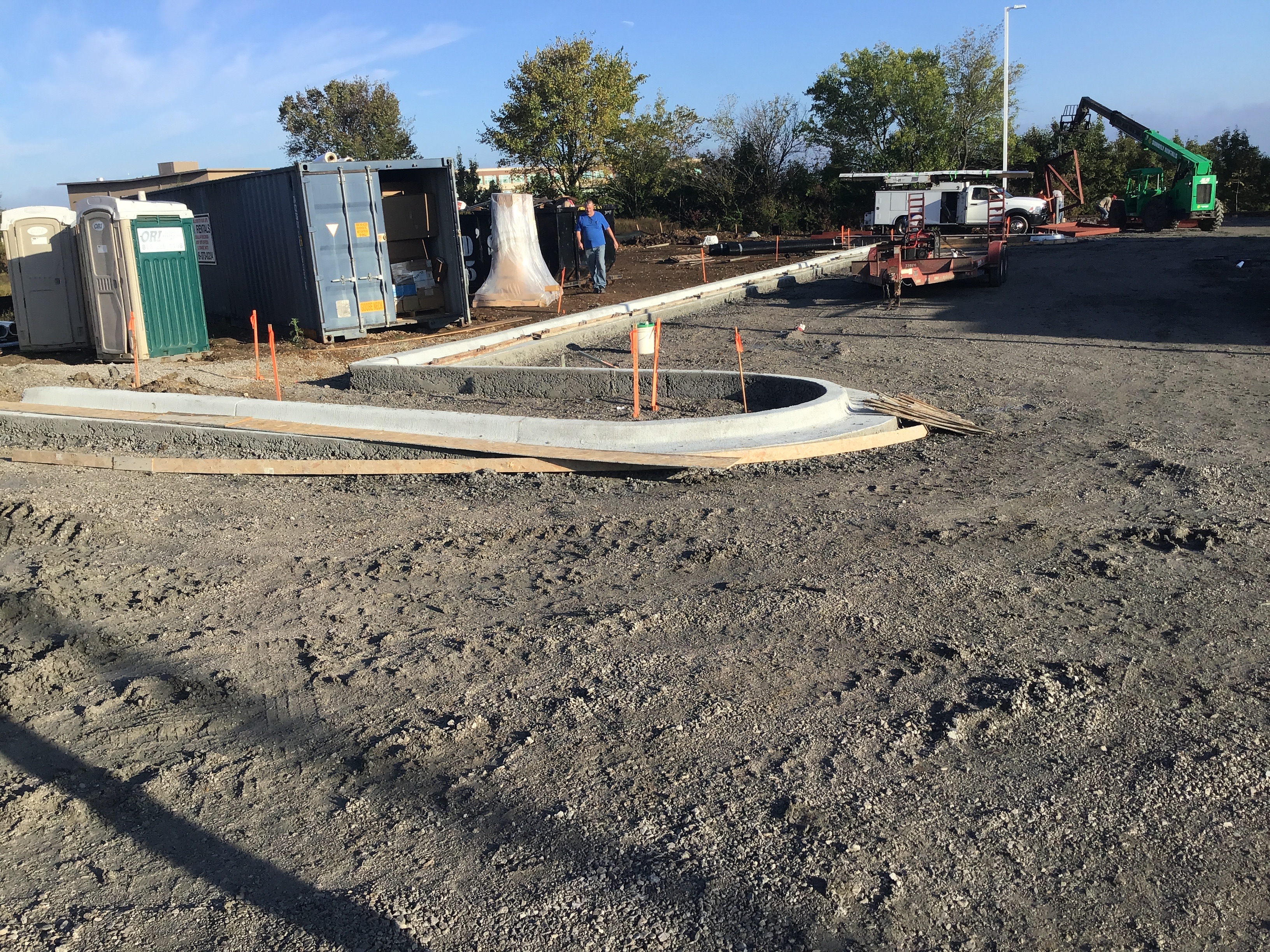

Curb - Proof Roll Passed 10/04/2021
Misc
Informational
10/04/2021
10/04/21 Monday Proof roll passed 1:30PM.
Piers/Caissons Inspection - Commercial Not Ready 10/7/2021 (3:00) 10/7/2021 10/07/2021
Misc
Informational
09/24/2021
Light pole piers Ok to pour, except LP 1 and 2 not ready
Miscellaneous Correction
Corrective Action Required
10/07/2021
TWO LIGHT POLE BASES FRONT PARKING LOT NOT DRILLED, NO REBAR, NO DRIVEN GROUND ROD Michael Harkins 10/07/2021 3:00 PM
Sprinkler - Hydrostatic Test Passed 10/8/2021 10/08/2021
Above Ceiling Inspection Passed 10/14/2021 10/13/2021 10/13/2021
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
08/10/2021
- RESTROOMS, POS AREA NORTH END - - SUSPENDED CEILING AREAS OK TO DROP CEILING TILE -
Pavement-Proof Roll Passed 10/20/2021
Misc
Informational
09/27/2021
9/27/21 Monday Contractor (Third party testing Co. Terracon) passed a the proof roll of parking lot of Whataburger. This was a subgrade proof roll. Proof roll on 6” of aggregate and stabilization will done tentatively later in the week. (Kansas City Test Co.) will be the Third party onsite proof roll of turn lane of Geogrid & 6” aggregate off of NE Douglas St tomorrow 9/28/21 Tuesday. 10/04/21 Monday Proof roll partially passed driveway center road and parking lot area close to back flow preventer needs to dry out more. 10/19/21 Tuesday Proof roll partially passed driveway Lon the NE Douglas ST. Side failed and parking lot at the front entrance Whataburger restaurant . Terrocon Testing was the Third Party inspection onsite for the proof roll. 10/20/21 Wednesday At 8:30AM proof roll one area failed approximately 14’X14’ but was stabilized and retested at 12:30PM. Third Party Inspection Terrocon Testing.
Pavement-Aggregate Base Passed 10/22/2021
Misc
Informational
10/21/2021

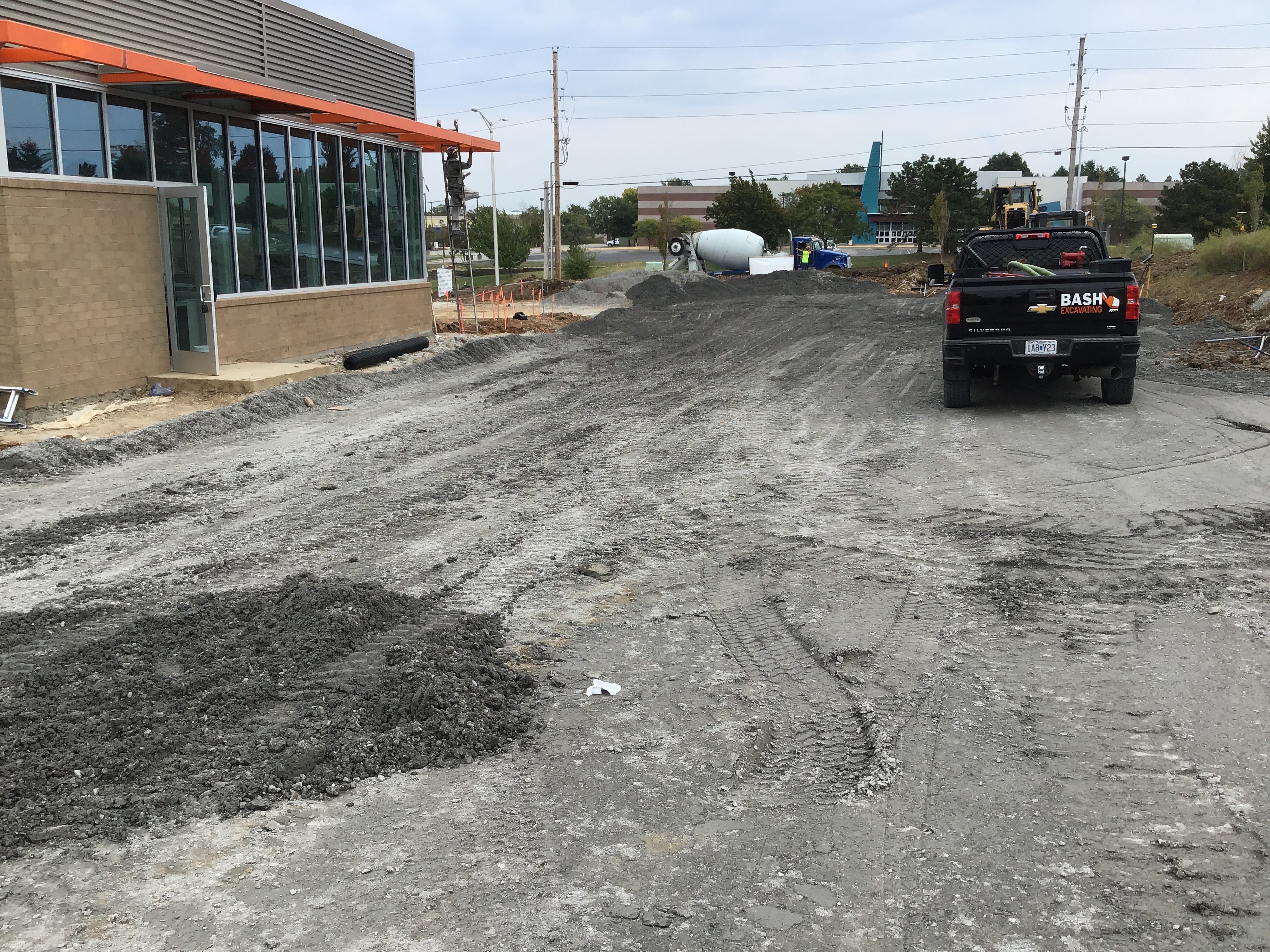

10/21/21 Thursday ( Seal.O.Matic paving Co.) Contractor began laying aggregate base type 5 @ 7:30AM. Seal.O.Matic was completed @ 6:30PM with laying base.
Fire Line - Hydrostatic Test Passed 10/25/2021
Misc
Informational
09/16/2021
9/16/21 Thursday 6” Private Water Line extension was tested @ 200psi for 2hrs starting at 10:05AM to 12:05AM. 9/17/21 Friday Fire Line pass test @ 200psi for 2hrs starting @ 12:05AM to 2:05AM.
Fire Line Construction Inspection Passed 10/25/2021
Misc
Informational
06/07/2021
6-1-21 9:25am Breit is on site. They are setting up to install the fire line riser in the building. 6-2-21 7:35am I spoke with my supervisor and CIP Inspectors about letting the contractor use C900 into the 90 degree for the riser. We all agreed that is fine. 6-7-21 1:23pm Breit is on site. They have the riser and one stick of C900 installed. They are starting to pour the thrust block now. 2:42pm The thrust block is poured.
Misc
Informational
10/25/2021
10/25/21 Monday Fire Line from the building was flushed for approximately 15 Minute it appears to be clear of any debris or dirt.
Rough Electrical Inspection - Commercial Passed 10/28/2021 10/28/2021
Underground Plumbing Inspection - Commercial Passed 10/28/2021 10/28/2021
Misc
Informational
09/09/2021
- 17' GREASE & VENT LINE EXITING BUILDING WEST SIDE - - GREASE INTERCEPTOR WEST OF BLDG OK TO COVER -
Underground Electrical Inspection - Commercial Passed 10/28/2021 10/28/2021
Misc
Informational
09/23/2021
- THE FOLOWING ITEMS ARE APPROVED - - TRANSFORMER TO BLDG NORTH SIDE - - CONDUIT FOR LIGHT POLE BASES OK TO COVER -
Piers/Caissons Inspection - Commercial Passed 10/8/2021 10/28/2021
Misc
Resolved
10/28/2021
Miscellaneous Correction
Resolved
10/28/2021
light pole bases complete
Alarm Test Passed 10/28/2021 10/28/2021
Alternate Protection Systems Inspection Passed 10/28/2021 10/28/2021
Sprinkler - Flow Test Passed 10/28/2021 10/28/2021
Occupancy Inspection - Codes Commercial Failed 10/28/2021
Miscellaneous Correction
Corrective Action Required
10/28/2021
An inspection was performed the Codes Administration and Fire departments. There are no unresolved items with the two disciplines. At this time the facility is released to stock and train staff until November 18, 2021. An occupancy inspection shall be performed with remaining departments prior to this date to release the facility for full service. Mike Weisenborn 10/28/2021 4:52 PM
Water Service Inspection Passed 11/09/2021
Fire Line Construction Inspection Passed 6/7/2021 6/7/2021 11/09/2021
Misc
Informational
06/02/2021
6-1-21 9:25am Breit is on site. They are setting up to install the fire line riser in the building. 6-2-21 7:35am I spoke with my supervisor and CIP Inspectors about letting the contractor use C900 into the 90 degree for the riser. We all agreed that is fine. 6-7-21 1:23pm Breit is on site. They have the riser and one stick of C900 installed. They are starting to pour the thrust block now. 2:42pm The thrust block is poured.
Misc
Informational
09/10/2021
9/10/21 Friday Contractor installed approximately (56’ of 6” )PVC 2/45 deg bends coming out the building with 1’ between them, then 24’ then a 45 deg bend 32’ then another 45 deg bend 9/9/21 Thursday. The Backflow Vault was installed and 28’ of 6” PVC fire line pipe laid to Backflow Vault then a piece out the backside of the Vault. Contractor poured backing blocks on 45 deg bends & straddle block with mega lug on the pipe coming out of the backside that will connect to the existing 8”. Also there is a 6”X6” Tee w/ (backing block) for fire hydrant located approximately 6’ West of Backflow Vault. Collars for vault was poured. 9/14/21 Tuesday (Breit Construction) Contractor installed approximately 35’ of 6” PVC fire line from 90 deg to the existing 8” water line tie done with a 6”x8” Tee was installed and 2/8” sleeve ( 30” from center tee to center of sleeves) on existing main. Water main was test shut by Lee’s Summits Water Department on 9/13/21. Note: Contractor was able to tie-in because of an unmarked Backflow Preventer that was buried where the new entrance is to be constructed. It allowed the contractor to isolate main with “8 valve on the property for tie-in with out shutting down service to any costumers 9/13/21 Monday. The hydrant to be removed does require that one costumer be out but they where notified that the water will be off for approximately 3hours starting at 12:00PM today. Backflow Preventer Lid will need to be raise to grade for new parking lot construction. The contractors Engineer and or Developer will ensure this information will be update to show actual Water Service utilities on site. See C1.0 details for Private Water Line extension For future Lots. 6”x”8 tee was installed and 8” sleeve 32” center to center to the South and a 8” 90 deg bend 3’ to the North of same 6”x8” tee. 9/15/21 Wednesday (Breit Construction) Private Water Line Extension as-per project plan C1.0 off newly installed 6”x8” tee. Contractor installed approximately 65’ of 6” PVC water main. 9/20/21 Monday (Breit Construction) Contractor chlorinated the Private Water Line Extension @ 2:00PM. 9/21/21 Tuesday (Breit Construction) Contractor de-chlorinated the Private Water Line Extension @ 3:00PM.
Site Visit Complete 11/09/2021
Misc
Informational
06/07/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time.
Site Visit Complete 6/8/2021 11/09/2021
Misc
Informational
06/07/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time.
Site Visit Complete 6/9/2021 11/09/2021
Misc
Informational
06/08/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time.
Site Visit Complete 6/11/2021 11/09/2021
Misc
Informational
06/09/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time.
Site Visit Complete 6/16/2021 6/16/2021 11/09/2021
Misc
Informational
06/15/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place.
Site Visit Complete 6/17/2021 11/09/2021
Misc
Informational
06/16/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time.
Site Visit Complete 6/21/2021 11/09/2021
Misc
Informational
06/17/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time.
Site Visit Complete 6/22/2021 11/09/2021
Misc
Informational
06/21/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time. 6-22-21 11:33am They are working on the beams for the building. No other work is taking place.
Site Visit Complete 6/23/2021 6/23/2021 11/09/2021
Misc
Informational
06/22/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time. 6-22-21 11:33am They are working on the beams for the building. No other work is taking place. 6-23-21 1:32pm There are no inspections needed at this time.
Site Visit Complete 7/6/2021 11/09/2021
Misc
Informational
06/23/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time. 6-22-21 11:33am They are working on the beams for the building. No other work is taking place. 6-23-21 1:32pm There are no inspections needed at this time. 7-6-21 8:17am Breit is on site to start digging for the underground detention basin. I informed them they will need a third party inspector for that scope of work. ARC are on site installing the lane drop. 2:11pm The lane drop is done and they will start working on the turn lane on 7-7-21. Breit is digging out for the dentin. 8/17/21 Contractor continued to cover the detention basin as required also Aspire the gas company started the relocation of their main as per project plans. 8/20/21 Friday Contractor has completed the 1.5’ of soil cover over gravel that is directly on the (underground detention basin). 8/23/21 Monday Contractor has been relocating fiber optics phone lines approximately 3’ West.
Site Visit Complete 11/09/2021
Misc
Informational
07/06/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time. 6-22-21 11:33am They are working on the beams for the building. No other work is taking place. 6-23-21 1:32pm There are no inspections needed at this time. 7-6-21 8:17am Breit is on site to start digging for the underground detention basin. I informed them they will need a third party inspector for that scope of work. ARC are on site installing the lane drop. 2:11pm The lane drop is done and they will start working on the turn lane on 7-7-21. Breit is digging out for the dentin. 9-23-21 2:20PM visited with site superintendent to discuss the installation of subgrade stabilization and proof roll of subgrade. 10-11-21 Site Visit no work on site erosion held. 10/26/21 Tuesday Contractors working onsite to prepare for grand opening. Parking lot has been striped, dumpster storage has been assembled, grading, and finalizing building construction items.
Fire Line - Hydrostatic Test Passed 11/09/2021
Misc
Informational
09/16/2021
9/16/21 Thursday 6” Private Water Line extension was tested @ 200psi for 2hrs starting at 10:05AM to 12:05AM. Hydrostatic test passed.
Pavement-Stabilized Subgrade Passed 11/09/2021
Misc
Informational
09/28/2021

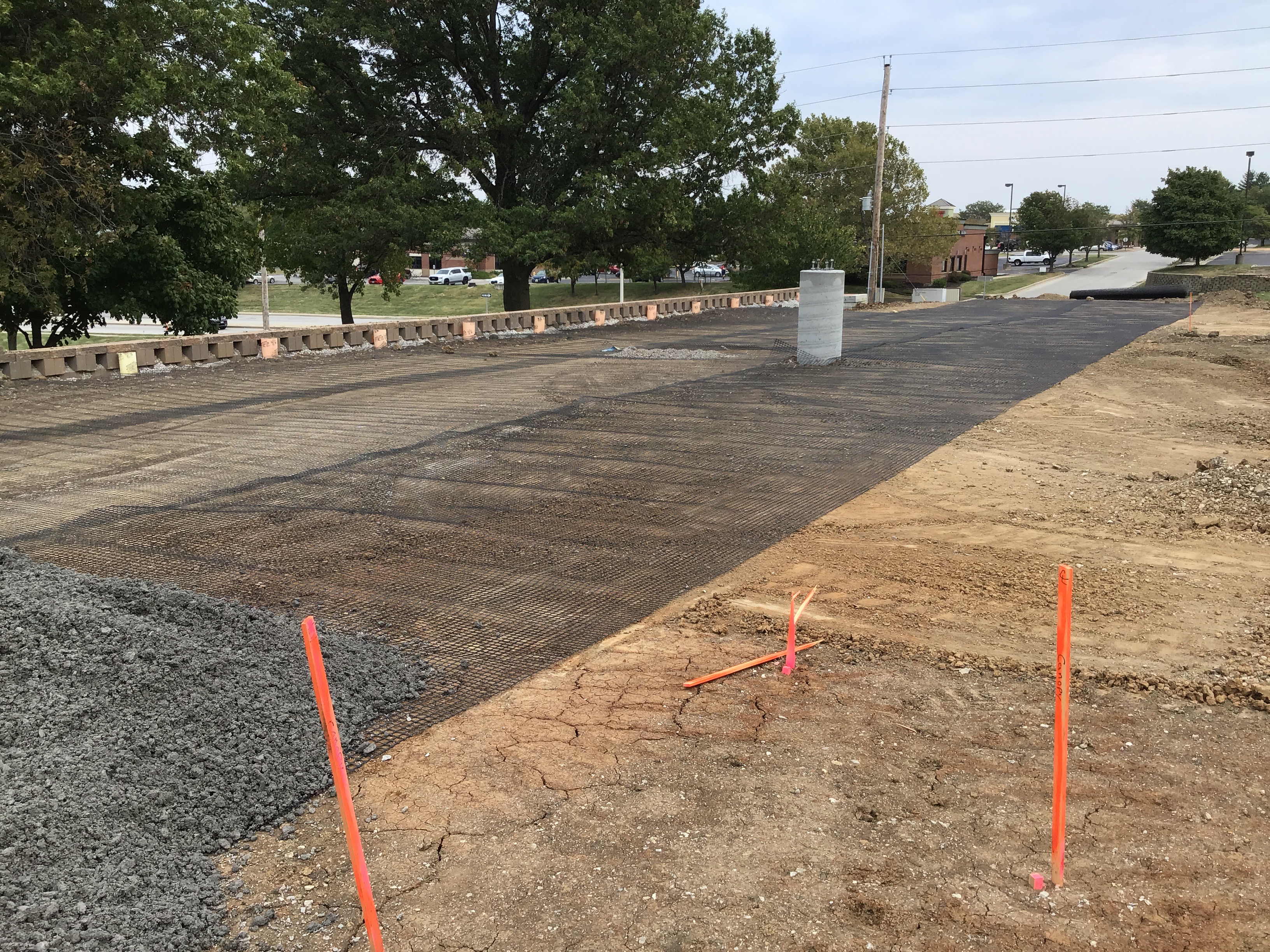

9/28/21 Tuesday Subcontractor Bash Excavating, LLC Contractor began installation of Geogrid (Terragrid Rx1100) for subgrade stabilization . Contractor got the correct Geogrid (Terragrid Rx1200) and continued installation of subgrade. 9/29/21 Wednesday Subcontractor Bash Exavating, LLC Contractor continued installing Geogrid around the parking lot. 10/01/21 Friday Contractor continued installation of Geogrid. 10/18/21 Monday Contractor continues to compact AB3 in Whataburger parking lot.
Pavement-Proof Roll Passed 11/09/2021
Misc
Informational
09/27/2021
9/27/21 Monday Contractor (Third party testing Co. Terracon) passed a the proof roll of parking lot of Whataburger. This was a subgrade proof roll. Proof roll on 6” of aggregate and stabilization will done tentatively later in the week. (Kansas City Test Co.) will be the Third party onsite proof roll of turn lane of Geogrid & 6” aggregate off of NE Douglas St tomorrow 9/28/21 Tuesday. 10/01/21 Friday Proof was done on the entire parking lot of the subgrade. Rule 5/ AB3 was installed and sufficient compacted around driveway and curbs connected with the building. Proof roll passed.
Site Visit Complete 11/09/2021
Misc
Informational
09/23/2021
6-7-21 11:20am The contractor is setting up to pour footings. No inspections are needed from me at this time. 6-8-21 1:11pm There are no inspections needed at this time. 6-9-21 1:57pm They are working on the plumbing inside the footings. No inspections are needed from me at this time. 6-11-21 2:53pm The is no work taking place on site at this time. 6-14-21 8:14am Artistic are working on the site pad to prepare for the slab pour. There are no inspections needed from me at this time. 6-15-21 9:44am 82 degrees. They are pouring the slab for the building. No inspections are needed from me at this time. 6-16-21 9:47am 85 degrees. The crew on site are preparing to go vertical wit the building. No other work is taking place. 6-17-21 3:07pm 99 degrees and full sun. They have gone vertical with the building. No inspections are needed from me at this time. 6-21-21 10:29am They are setting beams. There are no inspections needed from me at this time. 6-22-21 11:33am They are working on the beams for the building. No other work is taking place. 6-23-21 1:32pm There are no inspections needed at this time. 7-6-21 8:17am Breit is on site to start digging for the underground detention basin. I informed them they will need a third party inspector for that scope of work. ARC are on site installing the lane drop. 2:11pm The lane drop is done and they will start working on the turn lane on 7-7-21. Breit is digging out for the dentin. 9-23-21 2:20PM visited with site superintendent to discuss the installation of subgrade stabilization and proof roll of subgrade. 11/10/21 Wednesday Visited with the Gregg the Project Superintendent of the construction of the store about the progress and the upcoming grand opening. 04/06/22 Wednesday Visited the site to determine the readiness for Final Acceptance. Vegetation was covered except for an area 15’X90’ where the matting rolled up and needs to be re-pinned. A couple area around curbs & island need more soil due to settling of ground.
Pavement-Stabilized Subgrade Passed 11/09/2021
Misc
Informational
09/28/2021

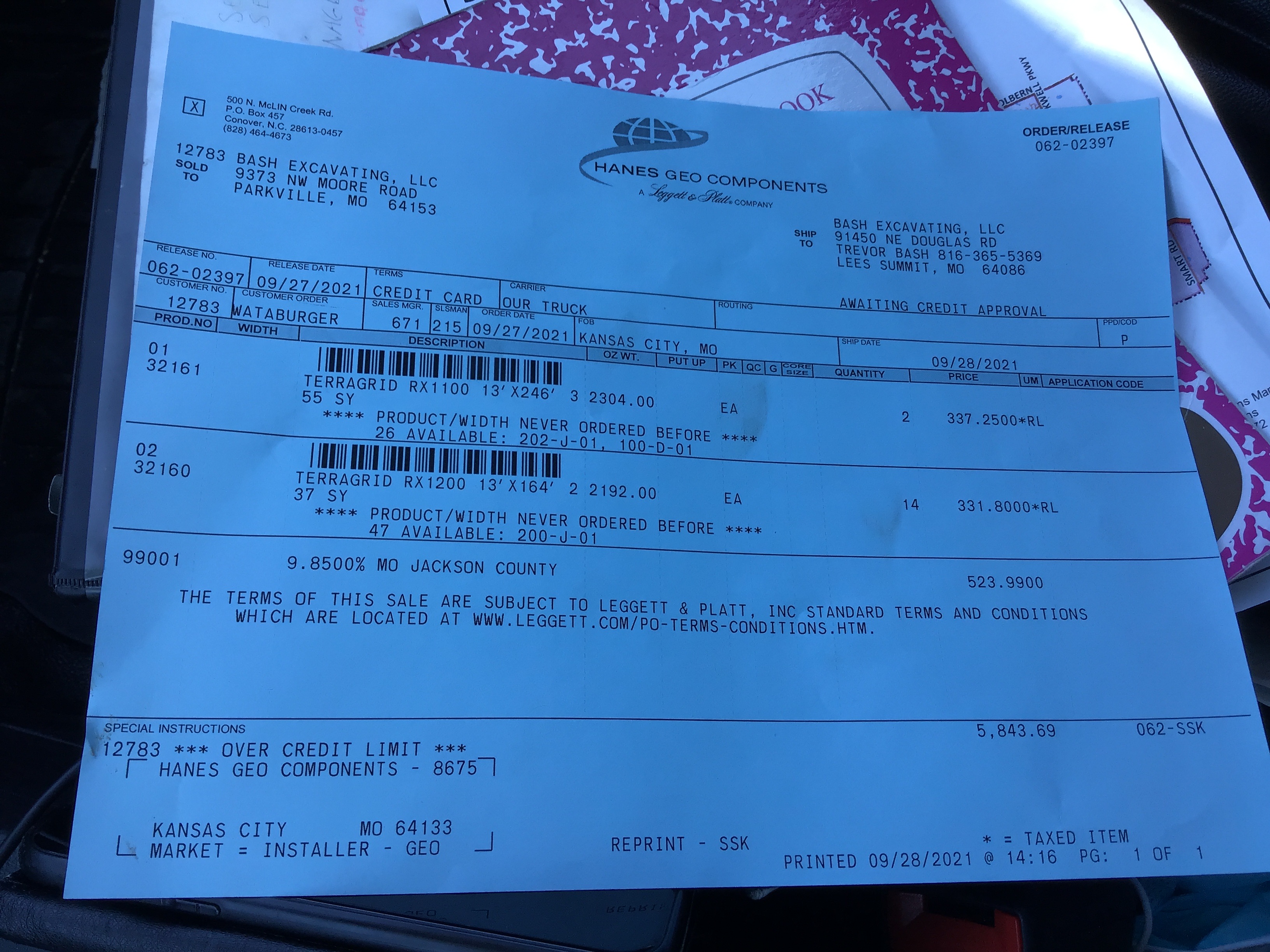

9/28/21 Tuesday Contractor began installation of Geogrid ( Terragrid Rx1100) for subgrade stabilization .
Pavement-Proof Roll Passed 11/09/2021
Misc
Informational

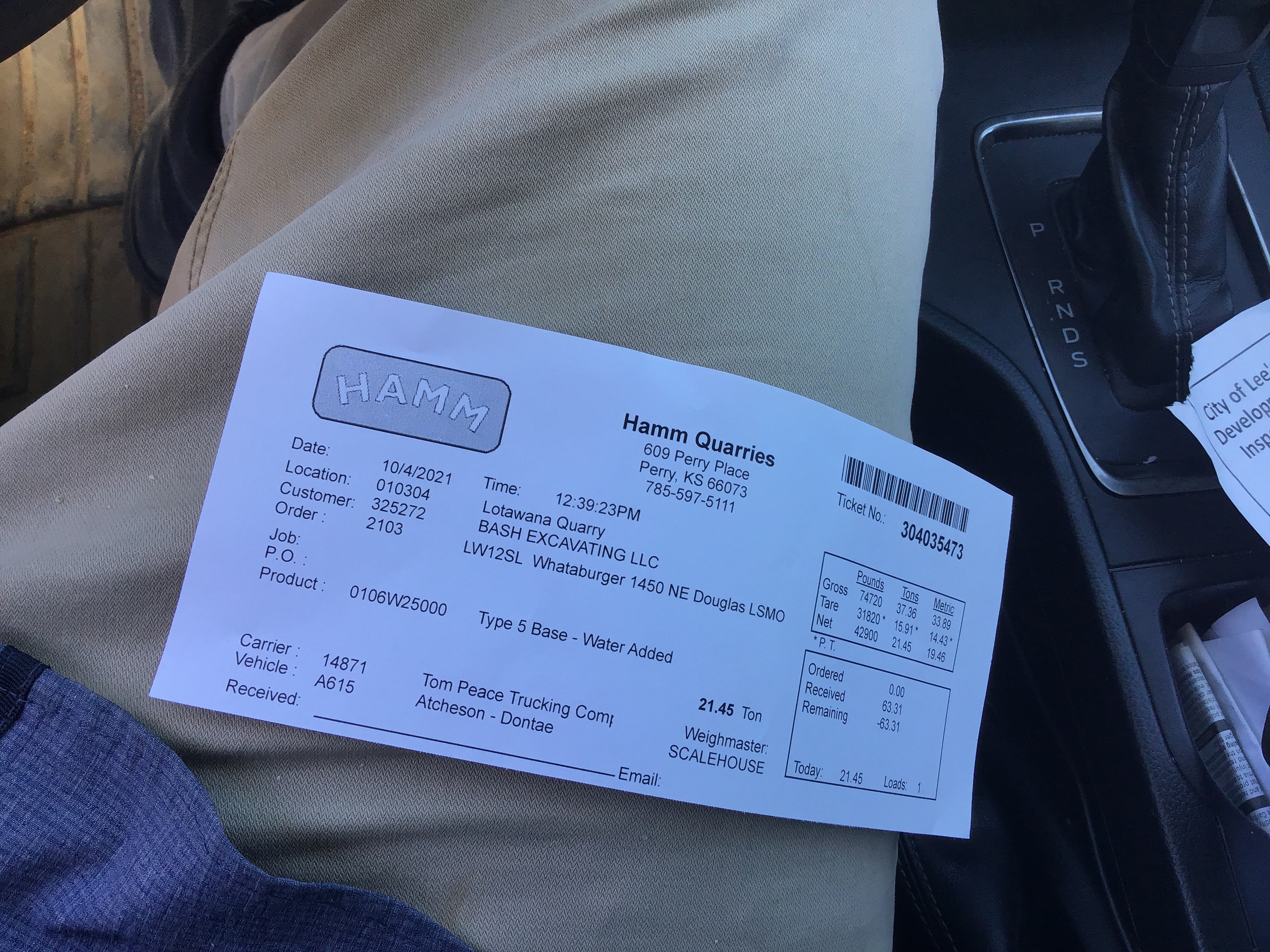

10/04/2021
9/27/21 Monday Contractor (Third party testing Co. Terracon) passed a the proof roll of parking lot of Whataburger. This was a subgrade proof roll. Proof roll on 6” of aggregate and stabilization will done tentatively later in the week. (Kansas City Test Co.) will be the Third party onsite proof roll of turn lane of Geogrid & 6” aggregate off of NE Douglas St tomorrow 9/28/21 Tuesday. 10/04/21 Monday Proof partially passed driveway center road and parking lot area close to back flow preventer needs to dry out more.
Commercial Curb Inspection Passed 11/09/2021
Misc
Informational
10/07/2021
10/07/21 Thursday Curbs where installed yesterday and today. 10/08/21 Friday Contractor continued to pour curbs on the commercial portion of property. Approximately 20 yards of concrete will be poured today. 10/14/21 Thursday The contractor will pour approximately 17yards of curbs for parking lot area. 10/15/21 Friday (Artistic Concrete Design Const.) Poured curbs around Dumpster Station & concrete pad for dumpster area.
Commercial Curb Inspection Passed 11/09/2021
Misc
Informational
10/07/2021
10/07/21 Thursday Curbs where installed yesterday and today.
Sidewalk Inspection Passed 11/09/2021
Misc
Informational
10/07/2021
10/07/21 Thursday Commercial sidewalk were installed in the front and South side of Whatabuger on 10/05/21. 10/16/21 Saturday (Artistic Concrete Design Const.) Contractor Poured the drive thru/ walkway and diagonal concrete pad in island around Whataburger. Special note: ADA Ramp connected to Whataburger’s sidewalk leading to the parking lot is not compliant. Landing Pad will be only 5’X3’. I discussed with Gregg the Superintendent of site and the concrete Subcontractor (Artistic Concrete) about the non-compliance,and they told me (Field Inspector John M. Jackson) “Whatabuger’s corporation ADA Engineer specialist to install 5’X3’ as-per plans. Reminded Josh of Artistic Concrete that all concrete needed to be cured 10/16/21 10:30AM. Public sidewalk: approximately 60’ of sidewalk & ADA ramp were poured 10/16/21 12:50PM.
Sidewalk Inspection Passed 11/09/2021
Misc
Informational
10/16/2021
10/07/21 Thursday Commercial sidewalk were installed in the front and South side of Whatabuger on 10/05/21. 10/16/21 Saturday (Artistic Concrete Design Const.) Contractor Poured the drive thru/ walkway and diagonal concrete pad in island around Whataburger. Special note: ADA Ramp connected to Whataburger’s sidewalk leading to the parking lot is not compliant. Landing Pad will be only 5’X3’. I discussed with Gregg the Superintendent of site and the concrete Subcontractor (Artistic Concrete) about the non-compliance,and they told me (Field Inspector John M. Jackson) “Whatabuger’s corporation ADA Engineer specialist to install 5’X3’ as-per plans.
Driveway Inspection Passed 11/09/2021
Misc
Informational
10/16/2021
10/16/21 Saturday (Artistic Concrete Design Const.) Contractor poured the drive through, walkway, & pads in island. This information is recorded in the curbs and sidewalk inspection. 10/19/21 Monday Contractor continued to grade and compact driveway.
Driveway Inspection Passed 11/09/2021
Misc
Informational
10/16/2021
10/16/21 Saturday (Artistic Concrete Design Const.) Contractor poured the drive through, walkway, & pads in island. This information is recorded in the curbs and sidewalk inspection.
Grading/Excavation/Fill Inspection Passed 11/09/2021
Misc
Informational
10/16/2021
10/16/21 Saturday (Artistic Concrete Design Const.) Contractor filled in islands around Whatabuger parking lot with soil backfill that will grow vegetation. 10/18/21 Monday (Bash Const.) Contractor filling in with soil backfill behind sidewalks and curbs.,
Grading/Excavation/Fill Inspection Passed 11/09/2021
Misc
Informational
10/16/2021
10/16/21 Saturday (Artistic Concrete Design Const.) Contractor filled in islands around Whatabuger parking lot with soil backfill that will grow vegetation.
Pavement-Aggregate Base Passed 11/09/2021
Misc
Informational

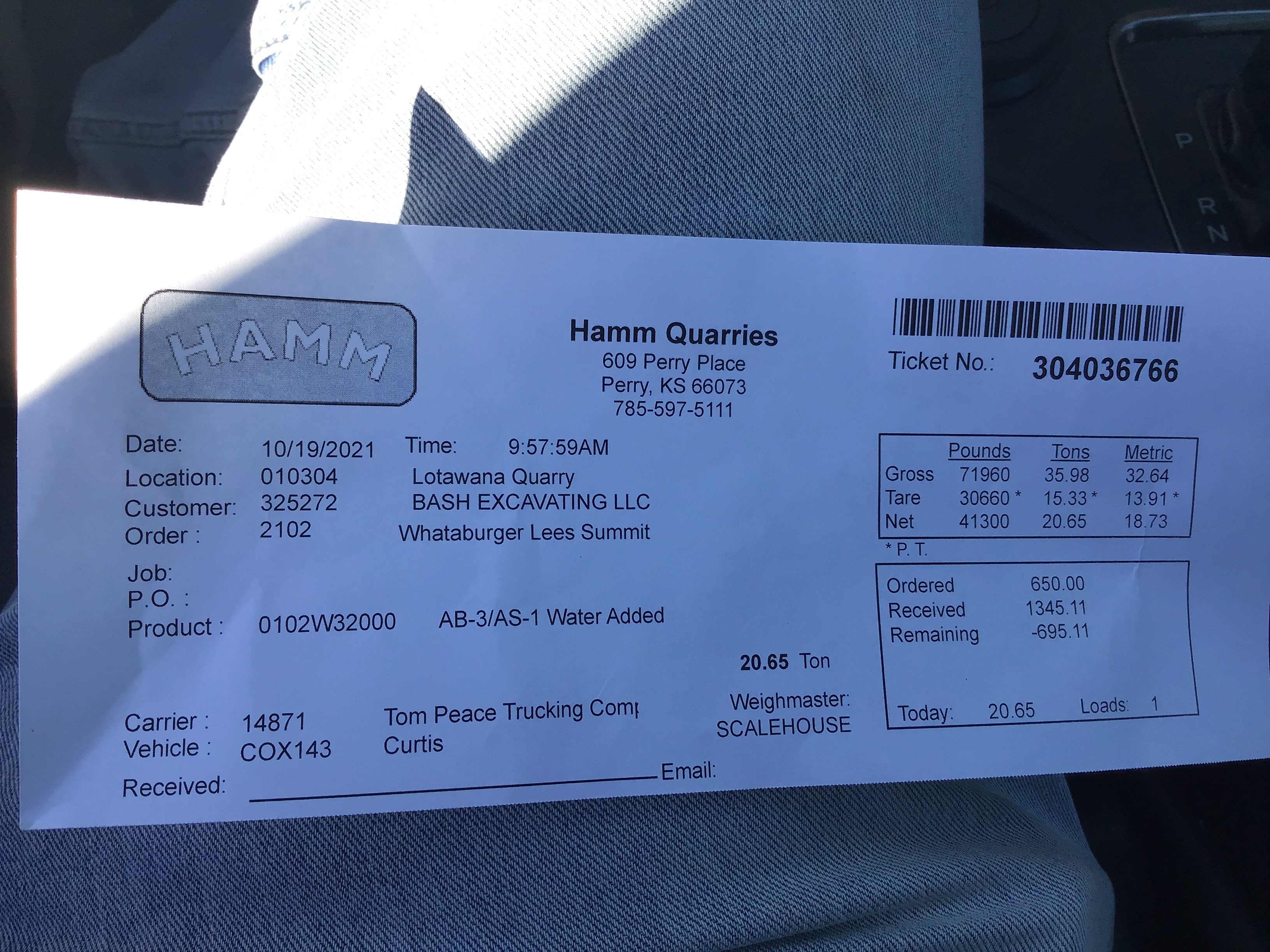

10/21/2021

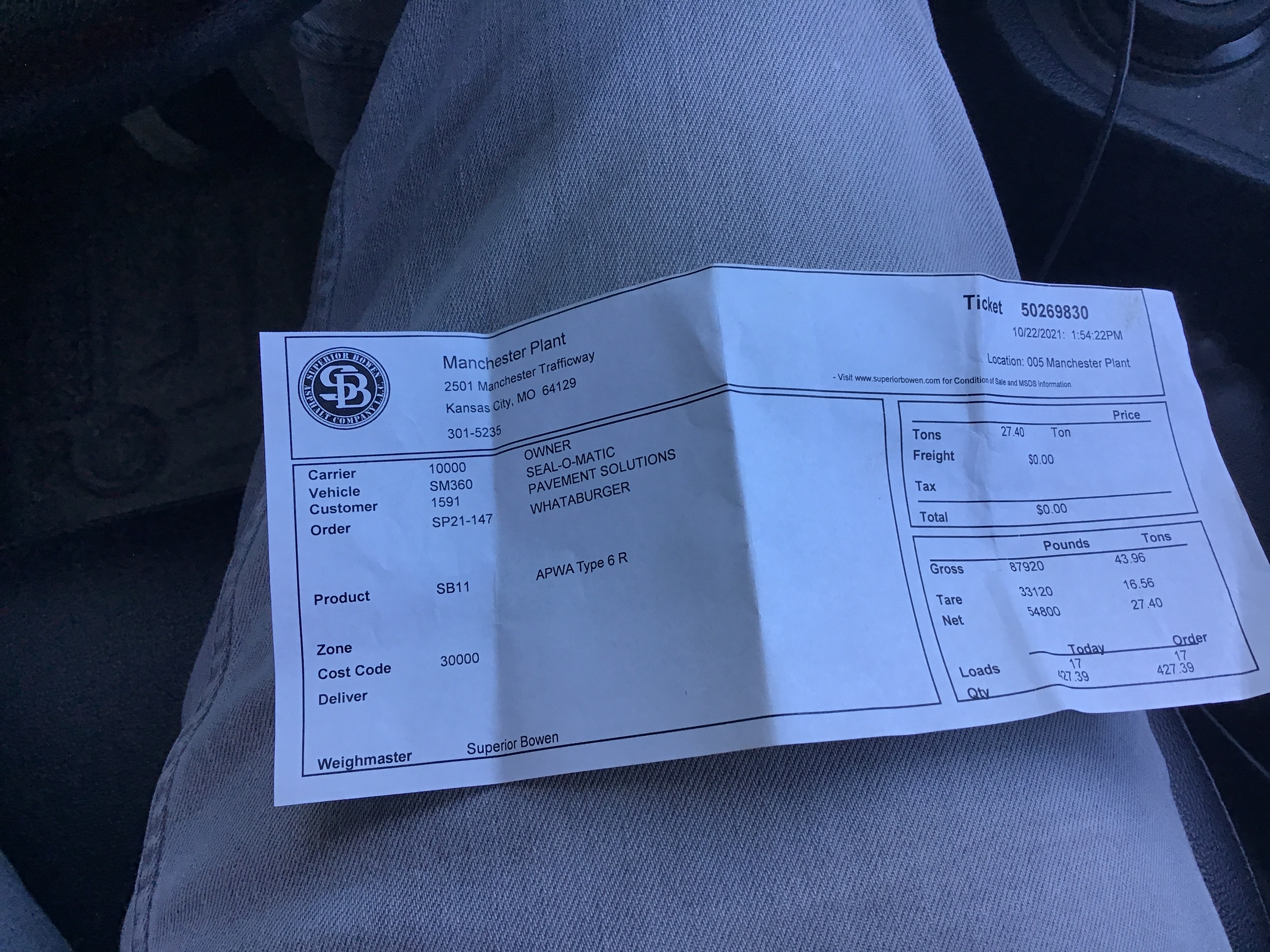

10/21/21 Thursday ( Seal.O.Matic paving Co.) Contractor began laying aggregate base type 5 @ 7:30AM.
Pavement-Surface Passed 11/09/2021
Misc
Informational
10/22/2021
Occupancy Inspection - Water Utilities Passed 11/4/2021 11/09/2021
Occupancy Inspection - Planning Passed 11/09/2021
Occupancy Inspection - Engineering Temporary C of O 11/1/2021 11/11/2021
Miscellaneous Correction
Corrective Action Required
11/11/2021
Re-establish vegitation
Occupancy Inspection - Codes Commercial Temporary C of O 11/11/2021 11/11/2021
Miscellaneous Correction
Resolved
11/11/2021
An inspection was performed the Codes Administration and Fire departments. There are no unresolved items with the two disciplines. At this time the facility is released to stock and train staff until November 18, 2021. An occupancy inspection shall be performed with remaining departments prior to this date to release the facility for full service. Mike Weisenborn 10/28/2021 4:52 PM
Miscellaneous Correction
Corrective Action Required
11/11/2021
Complete outstanding items under Field Engineering Inspections.
Underslab Electrical Inspection - Commercial Passed 6/11/2021 6/11/2021 12/20/2021
Occupancy Inspection - Codes Commercial Temporary C of O 1/12/2022 01/12/2022
Miscellaneous Correction
Corrective Action Required
11/11/2021
Complete outstanding items under Field Engineering Inspections.
Occupancy Inspection - Engineering Passed 07/21/2022
Miscellaneous Correction
Corrective Action Required
11/11/2021
Re-establish vegitation on distrubed areas.
Occupancy Inspection - Codes Commercial Full C of O 07/21/2022
Miscellaneous Correction
Corrective Action Required
01/12/2022
Complete outstanding items under Field Engineering Inspections.
Documents & Images
Date Uploaded File Type Document Name
12/23/2020 Application Form LS Commercial Building Permit App
12/23/2020 Plans WB-Lees Summit_Elect combined
12/23/2020 Plans WB-Lees Summit_Arch_combined
12/23/2020 Plans WB-Lees Summit_Mech combined
12/23/2020 Plans WB-Lees Summit_FAFP combined
12/23/2020 Plans WB-Lees Summit_STRUCT_combined
12/23/2020 Plans WB-Lees Summit_Plumb combined
12/30/2020 Letter Fire Building Plan Review
12/30/2020 Letter DS P/R Corrections Document
01/27/2021 Letter DS P_R Corrections Document
01/27/2021 Letter _plan review response letter
01/27/2021 Engineer Report/Study Logico2_mk9 model 2049_CO2 Detection System_Spec
01/27/2021 Specifications MVE CO2 Tank Spec
01/27/2021 Drawing Type I Whataburger Fry Hood Side View Zero Clearance
01/27/2021 Letter _Rev1 Narrative
01/27/2021 Plans WB-Lees Summit_Elect combined
01/27/2021 Engineer Report/Study Type I hood zero clearance letter
01/27/2021 Plans WB-Lees Summit_FAFP combined
01/27/2021 Plans WB-Lees Summit_Mech combined
01/27/2021 Plans WB-Lees Summit_Plumb combined
01/27/2021 Drawing WTB1496 Double side hood for 6ft grills 9 ft ceiling_Spec
01/27/2021 Drawing WTB1520 Wall hung fryer hood for 10 basket 9ft ceiling_Spec
01/27/2021 Plans WB-Lees Summit_Arch_combined
01/28/2021 Letter Fire Building Plan Review
01/29/2021 Plans WB-Lees Summit_Struct_combined
02/02/2021 3RD Party Insp Report New Food Establishment Plan Review - Approved FTG 0001149
04/13/2021 Application Form PinnacleConstruction_20210413_085425
04/13/2021 Approved Plans Approved - WB-Lees Summit_Struct_combined0
04/13/2021 Approved Plans approved - WB-Lees Summit_Arch_combined0
04/13/2021 Approved Plans approved - WB-Lees Summit_Elect combined0
04/13/2021 Approved Plans approved - WB-Lees Summit_Mech combined0
04/13/2021 Approved Plans approved - WB-Lees Summit_Plumb combined0
04/23/2021 Receipt Receipt for transaction:2021-002198
04/13/2021 Approved Plans Approved PL2020380 Whataburger Site Plans
05/13/2021 Letter DS Building Permit
05/13/2021 Letter License Tax Bill
06/02/2021 Letter INSPECTION SUMMARY
06/02/2021 Letter INSPECTION SUMMARY
06/07/2021 Letter INSPECTION SUMMARY
06/07/2021 Fire riser.jpg
06/07/2021 Letter INSPECTION SUMMARY
06/08/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
06/11/2021 Letter INSPECTION SUMMARY
06/11/2021 Letter INSPECTION SUMMARY
06/14/2021 Letter INSPECTION SUMMARY
06/15/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/17/2021 Letter INSPECTION SUMMARY
06/21/2021 Letter INSPECTION SUMMARY
06/22/2021 Letter INSPECTION SUMMARY
06/23/2021 Letter INSPECTION SUMMARY
07/06/2021 Letter INSPECTION SUMMARY
07/07/2021 Letter Fire (Sprinkler) Plan Review
07/23/2021 PJ2105190011 - Whataburger New FA
07/23/2021 000. Completed Final FA data sheets sb0128226_PJ2105190011_210609
07/23/2021 Letter Fire (Alarm) Plan Review Notice
07/29/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/04/2021 Letter INSPECTION SUMMARY
08/10/2021 Letter INSPECTION SUMMARY
08/17/2021 PJ2105190011 - Whataburger New FArev1
08/17/2021 Letter Fire (Alarm) Plan Review Notice
08/17/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 image.jpg
08/27/2021 Letter INSPECTION SUMMARY
09/08/2021 Letter INSPECTION SUMMARY
09/09/2021 Letter INSPECTION SUMMARY
09/10/2021 image.jpg0
09/10/2021 image.jpg1
09/10/2021 image.jpg2
09/10/2021 image.jpg3
09/10/2021 image.jpg4
09/10/2021 Letter INSPECTION SUMMARY
09/14/2021 image.jpg5
09/14/2021 image.jpg6
09/14/2021 image.jpg7
09/14/2021 image.jpg8
09/14/2021 image.jpg9
09/14/2021 image.jpg10
09/14/2021 image.jpg11
09/15/2021 Letter INSPECTION SUMMARY
09/15/2021 Receipt Receipt for transaction:2021-007337
09/15/2021 image.jpg12
09/16/2021 Letter INSPECTION SUMMARY
09/16/2021 Letter INSPECTION SUMMARY
09/16/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/21/2021 Letter INSPECTION SUMMARY
09/22/2021 Letter INSPECTION SUMMARY
09/22/2021 Letter INSPECTION SUMMARY
09/22/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/24/2021 Letter INSPECTION SUMMARY
09/27/2021 Letter INSPECTION SUMMARY
09/27/2021 Letter INSPECTION SUMMARY
09/28/2021 image.jpg13
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 image.jpg14
09/29/2021 Letter INSPECTION SUMMARY
09/29/2021 image.jpg15
09/29/2021 image.jpg16
09/29/2021 image.jpg17
09/29/2021 image.jpg18
10/04/2021 Letter INSPECTION SUMMARY
10/04/2021 Letter INSPECTION SUMMARY
10/04/2021 Letter INSPECTION SUMMARY
10/04/2021 image.jpg19
10/04/2021 Letter INSPECTION SUMMARY
10/04/2021 image.jpg20
10/07/2021 image.jpg21
10/07/2021 image.jpg22
10/07/2021 image.jpg23
10/07/2021 image.jpg24
10/07/2021 Letter INSPECTION SUMMARY
10/07/2021 Letter INSPECTION SUMMARY
10/07/2021 Letter INSPECTION SUMMARY
10/07/2021 Letter INSPECTION SUMMARY
10/08/2021 Letter INSPECTION SUMMARY
10/08/2021 Letter Fire Loss Reduction Form
10/11/2021 First Water Sample Lees Summit - What A Burger
10/11/2021 Second Water Sample Lees Summit - What A Berger
10/11/2021 Letter INSPECTION SUMMARY
10/13/2021 Letter INSPECTION SUMMARY
10/14/2021 image.jpg25
10/14/2021 image.jpg26
10/14/2021 image.jpg27
10/14/2021 image.jpg28
10/16/2021 image.jpg29
10/16/2021 image.jpg30
10/16/2021 image.jpg31
10/16/2021 image.jpg32
10/16/2021 Letter INSPECTION SUMMARY
10/16/2021 Letter INSPECTION SUMMARY
10/16/2021 image.jpg33
10/16/2021 Letter INSPECTION SUMMARY
10/16/2021 Letter INSPECTION SUMMARY
10/16/2021 image.jpg34
10/16/2021 image.jpg35
10/16/2021 image.jpg36
10/16/2021 image.jpg37
10/16/2021 image.jpg38
10/16/2021 65609638452__DE86EDFC-0E0D-4E89-8EF1-31AAB8F5422E.MOV
10/16/2021 image.jpg39
10/16/2021 image.jpg40
10/16/2021 image.jpg41
10/16/2021 Letter INSPECTION SUMMARY
10/16/2021 Letter INSPECTION SUMMARY
10/18/2021 image.jpg42
10/19/2021 Letter INSPECTION SUMMARY
10/19/2021 image.jpg43
10/20/2021 Letter INSPECTION SUMMARY
10/21/2021 image.jpg44
10/21/2021 Letter INSPECTION SUMMARY
10/21/2021 Letter INSPECTION SUMMARY
10/21/2021 image.jpg45
10/21/2021 65655122680__177062F6-0234-43AC-9B9D-473418C4AAE8.MOV
10/21/2021 image.jpg46
10/21/2021 image.jpg47
10/22/2021 Letter INSPECTION SUMMARY
10/22/2021 image.jpg48
10/22/2021 image.jpg49
10/25/2021 Letter INSPECTION SUMMARY
10/25/2021 Letter INSPECTION SUMMARY
10/25/2021 Letter INSPECTION SUMMARY
10/26/2021 Activity Document Interior devices and domestic service backflow
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter Fire Loss Reduction Form
10/28/2021 Letter Fire Loss Reduction Form
10/28/2021 Letter Fire Loss Reduction Form
10/28/2021 Letter INSPECTION SUMMARY
11/04/2021 Activity Document Fire line and irrigation backflow
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/11/2021 Receipt Receipt for transaction:2021-008695
11/11/2021 Letter INSPECTION SUMMARY
11/11/2021 Letter Codes Temporary Certificate of Occupancy
12/29/2021 Letter INSPECTION SUMMARY
01/12/2022 Letter Codes Temporary Certificate of Occupancy
07/21/2022 Letter Codes Final Certificate of Occupancy
08/02/2022 Letter Field Certificate of Occupancy
08/02/2022 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
