Permit Application Status

PRCOM20242901


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20242901
Building Permit - Commercial
Temporary Occupancy
ANACONDA LLC
NEW COMMERCIAL
SOUTH BUILDING A FLEX SPACE AND SITE DEVELOPMENT - NEW BUILDING WITH SPACES TO RENT FOR CONTRACTOR GARAGES
06/06/2024
09/11/2024
02/08/2025
Locations
Contacts
ANACONDA LLC, Address:1507 NE WALL ST
Capital Builders, LLC, Address:1507 NE Wall Street
Polar Aire Heating & Cooling Service, Address:400 S. Kansas Ave, Phone:(913) 782-8238
S & J Electrical Contractors, LLC, Address:7100 N. Oak Trafficway Ste. A
MILLER PLUMBING CO, Address:PO BOX 393 , Phone:(913) 851-1333
Matt Hendrickson, Address:1507 NE Wall Street, Phone:(816) 609-8633
SixTwentyOne, Address:1705 Summit St, Phone:(816) 694-1369
CFS ENGINEERS, Address:1421 EAST 104TH STREET STE 100, Phone:(816) 333-4477
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 08/20/2024 08/20/2024
Joe Frogge
Building Plan Review Approved with Conditions 08/27/2024 08/20/2024
Joe Frogge
Miscellaneous Correction
Corrective Action Required
08/20/2024

This plan review represents both buildings. After review process is complete another permit will be created as each building will have it's own. Action required: Comment is informational. 8/8/2024 - acknowledged in letter.
License Tax - Payment
Corrective Action Required
08/20/2024

A one-time impact fee in the form of a license tax must be collected before occupancy can be granted. Please be advised that additional application, review, and inspection fees do apply and additional information pertaining to this will be provided during that stage of your approval process. Action required: Comment is informational. We have processed this building as a Mini-Warehouse with a fee to be collected of $2,244.00. Any proposed uses other than warehouse will require a change of use permit and will be assessed for increased license tax fee and parking requirements. 8/8/2024 - acknowledged in letter.
Misc
Corrective Action Required
08/20/2024

Sanitary piping at Unit 1 is flowing in the wrong direction. Action required: Modify piping to comply. 8/8/2024 - Partially corrected. Field verify.
Fire Plan Review Approved with Conditions 08/27/2024 08/20/2024
Joe Frogge
Emergency power for illumination
Corrective Action Required
08/20/2024

Provide exterior emergency egress light. 2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits.
Building Plan Review Approved with Conditions 08/13/2024 08/20/2024
Joe Frogge
Miscellaneous Correction
Corrective Action Required
08/06/2024

This plan review represents both buildings. After review process is complete another permit will be created as each building will have it's own. Action required: Comment is informational. 8/8/2024 - acknowledged in letter.
IBC 1704.2 Special Inspections
Resolved
08/20/2024

2018 IBC 1704.2 Special inspections. Where application is made for construction as described in this section, the owner or the registered design professional in responsible charge acting as the owner’s agent shall employ one or more approved agencies to perform inspections during construction on the types of work listed under Section 1705. These inspections are in addition to the inspections identified in Lee’s Summit Code of Ordinances Chapter 7. (see code section for exceptions) Action required: Provide statement of special inspections / letter of responsibility from company contracted to perform special inspections. 8/8/2024 - Statement of special inspections must be from the actual inspection firm on their letterhead and must list out the inspections to be performed.
License Tax - Payment
Corrective Action Required
08/06/2024

A one-time impact fee in the form of a license tax must be collected before occupancy can be granted. Please be advised that additional application, review, and inspection fees do apply and additional information pertaining to this will be provided during that stage of your approval process. Action required: Comment is informational. We have processed this building as a Mini-Warehouse with a fee to be collected of $2,244.00. Any proposed uses other than warehouse will require a change of use permit and will be assessed for increased license tax fee and parking requirements. 8/8/2024 - acknowledged in letter.
Misc
Resolved
08/08/2024

Clarification required, Why is one building sprinklered while the other is not? Description of use is same for both.
IBC 1103.1 Where required - accessibility
Resolved
08/08/2024

ICC A117.1-2009 Section 403.5 Clear Width. The clear width of an accessible route shall be 36 inches minimum. Exception: The clear width shall be permitted to be reduced to 32 inches minimum for a length of 24 inches maximum provided the reduced width segments are separated by segments that are 48 inches minimum in length and 36 inches minimum in width. Action required: Modify design at shower in Unit 1 to comply.
ICC A117.1 304.3 Turning Space
Resolved
08/08/2024

ICC A117.1 Section 304.3 Size. Turning spaces shall comply with Section 304.3.1 or 304.3.2. 304.3.1 Circular Space. 304.3.1.1 New Buildings and facilities. In new buildings and facilities, the turning space shall be a circular space with a 67-inch minimum diameter. (see code for information regarding allowed overlapping) 304.3.1.2 Existing buildings and facilities. In existing buildings and facilities, the turning space shall be a circular space with a 60-inch minimum diameter. (see code for information regarding allowed overlapping) Action required: Modify design at shower in Unit 1 to comply. Turning space required at space in front of shower.
IPC 403.1 Minimum number of fixtures
Resolved
08/08/2024

2018 IPC 403.1 Minimum number of fixtures. Plumbing fixtures shall be provided in the minimum number shown in Table 403.1, based on the actual use of the building or space. Uses not shown in Table 403.1 shall be considered individually by the code official. The number of occupants shall be determined by the International Building Code. Action required: Provide mop sinks and drinking fountains. (or approved alternate)
Planning - Screening of ground mounted equipment
Resolved
08/20/2024

Unified Development Ordinance Article 8, Section 8.180.F Ground mounted equipment – Ground mounted equipment shall be totally screened from view by landscaping or masonry wall up to a height of the units to be screened. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section. (either masonry or approved evergreen plantings) 8/8/2024 - Landscaping designs must be resubmitted to the FDP.
IMC 307.2.3 Auxiliary condensate disposal
Resolved
08/08/2024

2018 IMC 307.2.3 Auxiliary and secondary drain systems. In addition to the requirements of Section 307.2.1, where damage to any building components could occur as a result of overflow from the equipment primary condensate removal system, one of the following auxiliary protection methods shall be provided for each cooling coil or fuel-fired appliance that produces condensate. (see code for 4 options) Action required: Given that the condensate connections to tailpipes is not in a conspicuous location, modify designs to comply.
NEC Article 210.8 (B) Other than dwelling units GFCI
Resolved
08/08/2024

2017 NEC Article 210.8 (B) Other Than Dwelling Units. All 125-volt, single-phase, 15- and 20-ampere receptacles installed in the locations specified in 210.8(B)(1) through (10) shall have ground-fault circuit-interrupter protection for personnel. (1) Bathrooms (2) Kitchens (3) Rooftops (4) Outdoors (5) Sinks - where receptacles are installed within 6 feet of the outside edge of the sink. (6) Indoor wet locations (7) Locker rooms with associated showering facilities (8) Garages, service bays, and similar areas other than vehicle exhibition halls and showrooms. (9) Crawl spaces – at or below grade level. (10) Unfinished portions or areas of the basement not intended as habitable rooms. (refer to code for exceptions) Action required: Modify drawings to show that all receptacles in garage bays will by GFCI protected.
NEC Article 250.50 Grounding electrode system
Resolved
08/08/2024

2017 NEC Article 250.50 Grounding Electrode System. All Grounding electrodes as described in 250.52(A)(1) through (A)(7) that are present at each building or structure served shall be bonded together to form the grounding electrodes system. Where none of these grounding electrodes exist, one or more of the grounding electrodes specified in 250.52(A)(4) through (A)(8) shall be installed and used. (see code section for exception) Action required: Provide grounding to all locations listed in this section including water piping, building steel, and concrete encased electrode.
IBC 1008.3 Emergency power for illumination - at exit discharge
Resolved
08/08/2024

2018 IBC 1008.3 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises’ electrical supply. 1008.3.1 General. In the event of power supply failure in rooms and spaces that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Aisles. 2. Corridors. 3. Exit access stairways and ramps. 1008.3.2 Buildings. In the event of power supply failure in buildings that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Interior exit access stairways and ramps. 2. Interior and exterior exit stairways and ramps. 3. Exit passageways. 4. Vestibules and areas on the level of discharge used for exit discharge in accordance with Section 1028.1. 5. Exterior landings as required by Section 1010.1.6 for exit doorways that lead directly to the exit discharge. 1008.3.3 Rooms and Spaces. In the event of power supply failure an emergency electrical system shall automatically illuminate all of the following areas: 1. Electrical equipment rooms. 2. Fire command centers. 3. Fire pump rooms. 4. Generator rooms. 5. Public restrooms with an area greater than 300 square feet. Action required: Provide emergency lighting at exterior landings.
Misc
Corrective Action Required
08/06/2024

Sanitary piping at Unit 1 is flowing in the wrong direction. Action required: Modify piping to comply. 8/8/2024 - Partially corrected. Field verify.
IPC 504.6 Water heater discharge piping
Resolved
08/08/2024

2018 IPC 504.6 Requirements for discharge piping. The discharge piping serving a pressure relief valve, temperature relief valve or combination thereof shall: 1. Not be directly connected to the drainage system. 2. Discharge through an air gap located in the same room as the water heater. 3. Not be smaller than the diameter of the outlet of the valve served and shall discharge full size to the air gap. 4. Serve a single relief device and shall not connect to piping serving any other relief device or equipment. 5. Discharge to the floor, to the pan serving the water heater or storage tank, to a waste receptor or to the outdoors. 6. Discharge in a manner that does not cause personal injury or structural damage. 7. Discharge to a termination point that is readily observable by the building occupants. 8.Not be trapped. 9. Be installed so as to flow by gravity. 10. Terminate not more than 6 inches above and not less than two times the discharge pipe diameter above the floor or flood level rim of the waste receptor. 11. Not have a threaded connection at the end of such piping. 12. Not have valves or tee fittings. 13. Be constructed of those materials listed in Section 605.4 or materials tested, rated and approved for such use in accordance with ASME A112.4.1. 14. Be one nominal size larger than the size of the relief valve outlet, where the relief valve discharge piping is installed with insert fittings. The outlet end of such tubing shall be fastened in place. Action required: Reference item 7. Modify designs to comply.
Misc
Resolved
08/08/2024

607.1 Where required. In residential occupancies, hot water shall be supplied to plumbing fixtures and equipment utilized for bathing, washing, culinary purposes, cleansing, laundry or building maintenance. In nonresidential occupancies, hot water shall be supplied for culinary purposes, cleansing, laundry or building maintenance purposes. In nonresidential occupancies, hot water or tempered water shall be supplied for bathing and washing purposes. Action required: Provide means of hot water at each suite for cleaning and maintenance.
IPC 608.1 Backflow
Resolved
08/08/2024

2018 IPC 608.1 General. A potable water supply system shall be designed, installed and maintained in such a manner so as to prevent contamination from nonpotable liquids, solids or gases being introduced into the potable water supply through cross-connections or any other piping connections to the system. Backflow preventer applications shall conform to Table 608.1, except as specifically stated in Sections 608.2 through 608.17.10. Action required: Comment is informational. While backflow protection is only required at the service entry location we highly recommend that protection is also provided per suite to protect potential industrial tenants from each other. 8/8/2024 - acknowledged in letter. - to be covered during tenant permits
Fire Plan Review Approved with Conditions 08/13/2024 08/12/2024
Craig Hill
Emergency power for illumination
Corrective Action Required
08/06/2024

Provide exterior emergency egress light. 2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits.
Licensed Contractors Approved 08/13/2024 08/08/2024
Joe Frogge
Fire Plan Review Approved with Conditions 07/03/2024 07/03/2024
Craig Hill
Emergency power for illumination
Corrective Action Required
07/03/2024

Provide exterior emergency egress light. 2018 IFC 1008.3.1 & 3.2 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises' electrical supply. In the event of power supply failure, an emergency electrical system shall automatically illuminate all of the following: 1. Aisles and unenclosed egress stairways in rooms and spaces that require two or mor means of egress. 2. Corridors, interior exit stairways and ramps and exit passageways in buildings required to have two or more exits. 3. Exterior egress components at other than their levels of exit discharge until exit discharge is accomplished for buildings required to have two or more exits.
Final Development Plan Review Approved 07/04/2024 07/01/2024
Scott Ready
Building Plan Review Rejected 07/03/2024 07/01/2024
Joe Frogge
Miscellaneous Correction
Corrective Action Required
07/01/2024

This plan review represents both buildings. After review process is complete another permit will be created as each building will have it's own. Action required: Comment is informational.
IBC 1704.2 Special Inspections
Corrective Action Required
07/01/2024

2018 IBC 1704.2 Special inspections. Where application is made for construction as described in this section, the owner or the registered design professional in responsible charge acting as the owner’s agent shall employ one or more approved agencies to perform inspections during construction on the types of work listed under Section 1705. These inspections are in addition to the inspections identified in Lee’s Summit Code of Ordinances Chapter 7. (see code section for exceptions) Action required: Provide statement of special inspections / letter of responsibility from company contracted to perform special inspections.
License Tax - Payment
Corrective Action Required
07/01/2024

A one-time impact fee in the form of a license tax must be collected before occupancy can be granted. Please be advised that additional application, review, and inspection fees do apply and additional information pertaining to this will be provided during that stage of your approval process. Action required: Comment is informational. We have processed this building as a Mini-Warehouse with a fee to be collected of $2,244.00. Any proposed uses other than warehouse will require a change of use permit and will be assessed for increased license tax fee and parking requirements.
Misc
Corrective Action Required
07/01/2024

Clarification required, Why is one building sprinklered while the other is not? Description of use is same for both.
IBC 1103.1 Where required - accessibility
Corrective Action Required
07/01/2024

ICC A117.1-2009 Section 403.5 Clear Width. The clear width of an accessible route shall be 36 inches minimum. Exception: The clear width shall be permitted to be reduced to 32 inches minimum for a length of 24 inches maximum provided the reduced width segments are separated by segments that are 48 inches minimum in length and 36 inches minimum in width. Action required: Modify design at shower in Unit 1 to comply.
ICC A117.1 304.3 Turning Space
Corrective Action Required
07/01/2024

ICC A117.1 Section 304.3 Size. Turning spaces shall comply with Section 304.3.1 or 304.3.2. 304.3.1 Circular Space. 304.3.1.1 New Buildings and facilities. In new buildings and facilities, the turning space shall be a circular space with a 67-inch minimum diameter. (see code for information regarding allowed overlapping) 304.3.1.2 Existing buildings and facilities. In existing buildings and facilities, the turning space shall be a circular space with a 60-inch minimum diameter. (see code for information regarding allowed overlapping) Action required: Modify design at shower in Unit 1 to comply. Turning space required at space in front of shower.
IPC 403.1 Minimum number of fixtures
Corrective Action Required
07/01/2024

2018 IPC 403.1 Minimum number of fixtures. Plumbing fixtures shall be provided in the minimum number shown in Table 403.1, based on the actual use of the building or space. Uses not shown in Table 403.1 shall be considered individually by the code official. The number of occupants shall be determined by the International Building Code. Action required: Provide mop sinks and drinking fountains. (or approved alternate)
Planning - Screening of ground mounted equipment
Corrective Action Required
07/01/2024

Unified Development Ordinance Article 8, Section 8.180.F Ground mounted equipment – Ground mounted equipment shall be totally screened from view by landscaping or masonry wall up to a height of the units to be screened. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section. (either masonry or approved evergreen plantings)
IMC 307.2.3 Auxiliary condensate disposal
Corrective Action Required
07/01/2024

2018 IMC 307.2.3 Auxiliary and secondary drain systems. In addition to the requirements of Section 307.2.1, where damage to any building components could occur as a result of overflow from the equipment primary condensate removal system, one of the following auxiliary protection methods shall be provided for each cooling coil or fuel-fired appliance that produces condensate. (see code for 4 options) Action required: Given that the condensate connections to tailpipes is not in a conspicuous location, modify designs to comply.
NEC Article 210.8 (B) Other than dwelling units GFCI
Corrective Action Required
07/01/2024

2017 NEC Article 210.8 (B) Other Than Dwelling Units. All 125-volt, single-phase, 15- and 20-ampere receptacles installed in the locations specified in 210.8(B)(1) through (10) shall have ground-fault circuit-interrupter protection for personnel. (1) Bathrooms (2) Kitchens (3) Rooftops (4) Outdoors (5) Sinks - where receptacles are installed within 6 feet of the outside edge of the sink. (6) Indoor wet locations (7) Locker rooms with associated showering facilities (8) Garages, service bays, and similar areas other than vehicle exhibition halls and showrooms. (9) Crawl spaces – at or below grade level. (10) Unfinished portions or areas of the basement not intended as habitable rooms. (refer to code for exceptions) Action required: Modify drawings to show that all receptacles in garage bays will by GFCI protected.
NEC Article 250.50 Grounding electrode system
Corrective Action Required
07/01/2024

2017 NEC Article 250.50 Grounding Electrode System. All Grounding electrodes as described in 250.52(A)(1) through (A)(7) that are present at each building or structure served shall be bonded together to form the grounding electrodes system. Where none of these grounding electrodes exist, one or more of the grounding electrodes specified in 250.52(A)(4) through (A)(8) shall be installed and used. (see code section for exception) Action required: Provide grounding to all locations listed in this section including water piping, building steel, and concrete encased electrode.
IBC 1008.3 Emergency power for illumination - at exit discharge
Corrective Action Required
07/01/2024

2018 IBC 1008.3 Emergency power for illumination. The power supply for means of egress illumination shall normally be provided by the premises’ electrical supply. 1008.3.1 General. In the event of power supply failure in rooms and spaces that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Aisles. 2. Corridors. 3. Exit access stairways and ramps. 1008.3.2 Buildings. In the event of power supply failure in buildings that require two or more means of egress, an emergency electrical system shall automatically illuminate all of the following areas: 1. Interior exit access stairways and ramps. 2. Interior and exterior exit stairways and ramps. 3. Exit passageways. 4. Vestibules and areas on the level of discharge used for exit discharge in accordance with Section 1028.1. 5. Exterior landings as required by Section 1010.1.6 for exit doorways that lead directly to the exit discharge. 1008.3.3 Rooms and Spaces. In the event of power supply failure an emergency electrical system shall automatically illuminate all of the following areas: 1. Electrical equipment rooms. 2. Fire command centers. 3. Fire pump rooms. 4. Generator rooms. 5. Public restrooms with an area greater than 300 square feet. Action required: Provide emergency lighting at exterior landings.
Misc
Corrective Action Required
07/01/2024

Sanitary piping at Unit 1 is flowing in the wrong direction. Action required: Modify piping to comply.
IPC 504.6 Water heater discharge piping
Corrective Action Required
07/01/2024

2018 IPC 504.6 Requirements for discharge piping. The discharge piping serving a pressure relief valve, temperature relief valve or combination thereof shall: 1. Not be directly connected to the drainage system. 2. Discharge through an air gap located in the same room as the water heater. 3. Not be smaller than the diameter of the outlet of the valve served and shall discharge full size to the air gap. 4. Serve a single relief device and shall not connect to piping serving any other relief device or equipment. 5. Discharge to the floor, to the pan serving the water heater or storage tank, to a waste receptor or to the outdoors. 6. Discharge in a manner that does not cause personal injury or structural damage. 7. Discharge to a termination point that is readily observable by the building occupants. 8.Not be trapped. 9. Be installed so as to flow by gravity. 10. Terminate not more than 6 inches above and not less than two times the discharge pipe diameter above the floor or flood level rim of the waste receptor. 11. Not have a threaded connection at the end of such piping. 12. Not have valves or tee fittings. 13. Be constructed of those materials listed in Section 605.4 or materials tested, rated and approved for such use in accordance with ASME A112.4.1. 14. Be one nominal size larger than the size of the relief valve outlet, where the relief valve discharge piping is installed with insert fittings. The outlet end of such tubing shall be fastened in place. Action required: Reference item 7. Modify designs to comply.
Misc
Corrective Action Required
07/01/2024

607.1 Where required. In residential occupancies, hot water shall be supplied to plumbing fixtures and equipment utilized for bathing, washing, culinary purposes, cleansing, laundry or building maintenance. In nonresidential occupancies, hot water shall be supplied for culinary purposes, cleansing, laundry or building maintenance purposes. In nonresidential occupancies, hot water or tempered water shall be supplied for bathing and washing purposes. Action required: Provide means of hot water at each suite for cleaning and maintenance.
IPC 608.1 Backflow
Corrective Action Required
07/01/2024

2018 IPC 608.1 General. A potable water supply system shall be designed, installed and maintained in such a manner so as to prevent contamination from nonpotable liquids, solids or gases being introduced into the potable water supply through cross-connections or any other piping connections to the system. Backflow preventer applications shall conform to Table 608.1, except as specifically stated in Sections 608.2 through 608.17.10. Action required: Comment is informational. While backflow protection is only required at the service entry location we highly recommend that protection is also provided per suite to protect potential industrial tenants from each other.
Licensed Contractors Approved 07/04/2024 06/24/2024
Joe Frogge
Special Inspections Review Pending
Joe Frogge
Fees
Paid Fees Amount Paid Owing Date Paid
Valuation Fee for New Commercial $2,000.00 $2,000.00 Paid 09/09/2024
Industrial/Warehouse Excise Tax Fee $2,244.00 $2,244.00 Paid 09/09/2024
Sanitary Sewer Insp Fees $249.60 $249.60 Paid 09/09/2024
Water Insp Fee $378.00 $378.00 Paid 09/09/2024
Storm Sewer Inspection Fee $9,546.60 $9,546.60 Paid 09/09/2024
Paved Surface Inspection Fee $6,126.08 $6,126.08 Paid 09/09/2024
Site Grading Fee $1,211.28 $1,211.28 Paid 09/09/2024
Water Meter Fee $4,129.40 $4,129.40 Paid 09/09/2024
Water Tap Fee $13,245.00 $13,245.00 Paid 09/09/2024
Sanitary Sewer Development Fee $7,609.00 $7,609.00 Paid 09/09/2024
Right of Way Permit Fee $85.00 $85.00 Paid 09/09/2024
Not Ready Inspection Fee $75.00 $75.00 Paid 08/18/2025
After Hours Inspections (Public Works)(Per Hour) $75.00 $75.00 Paid 08/18/2025
Not Ready Inspection Fee $75.00 $75.00 Paid 08/28/2025
Temporary Occupancy Fee $50.00 $50.00 Paid 09/03/2025
Temporary Occupancy Fee $50.00 $50.00 Paid 10/27/2025
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water Service Inspection Pending
Piers/Caissons Inspection - Commercial Pending
Gas Service Inspection - Commercial Pending
Pavement-Surface Pending
Misc
Corrective Action Required
08/01/2025

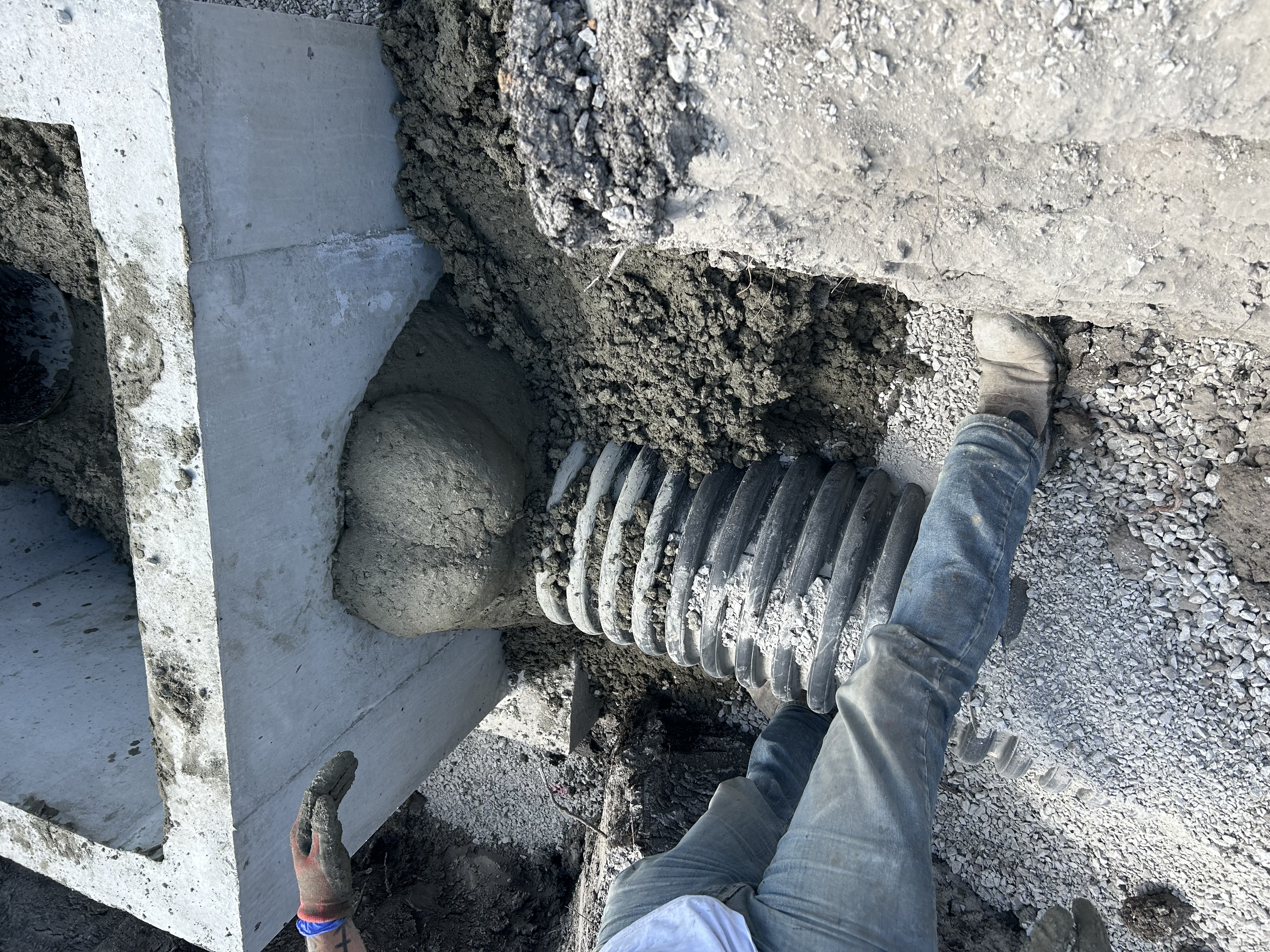

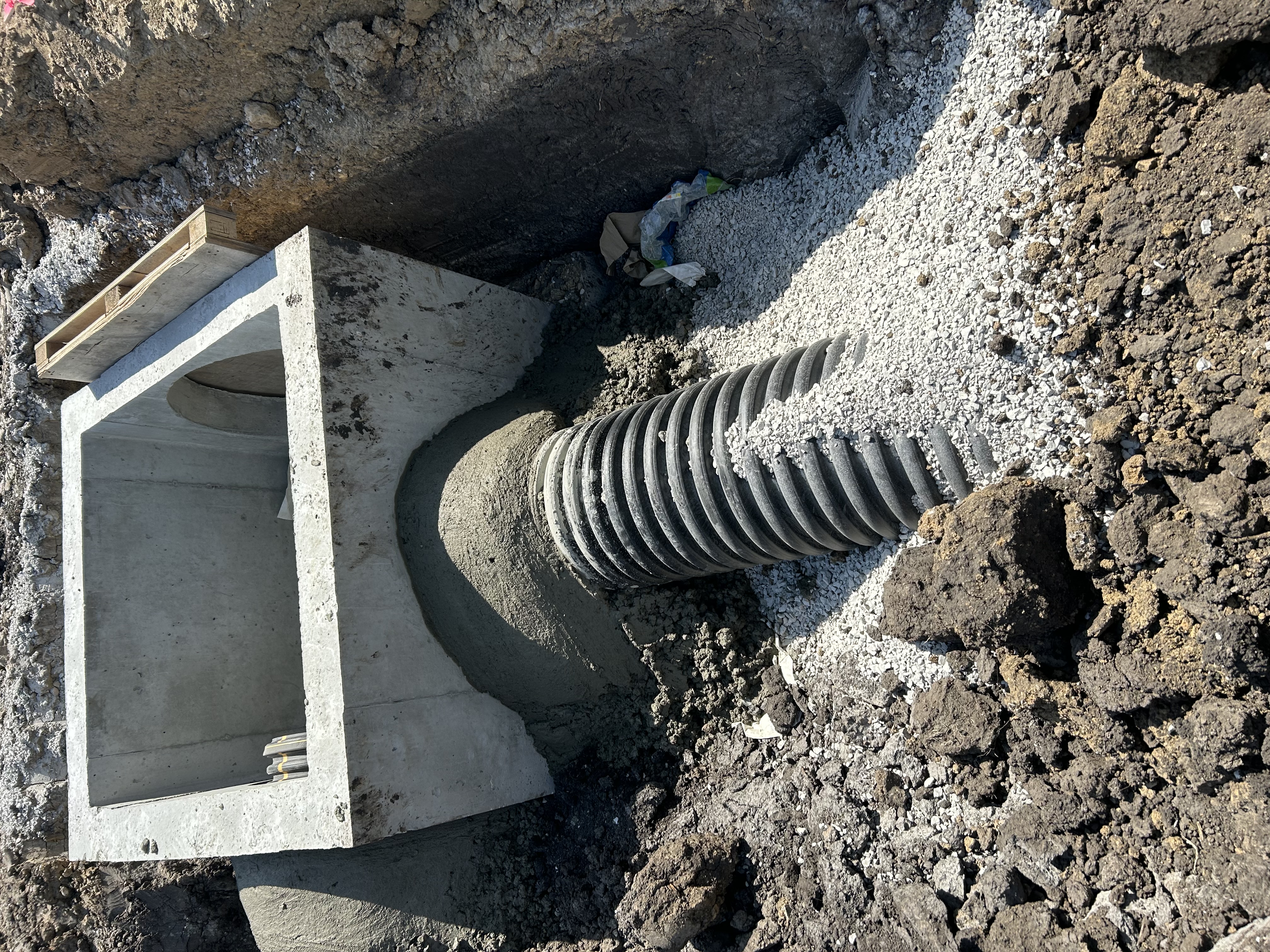

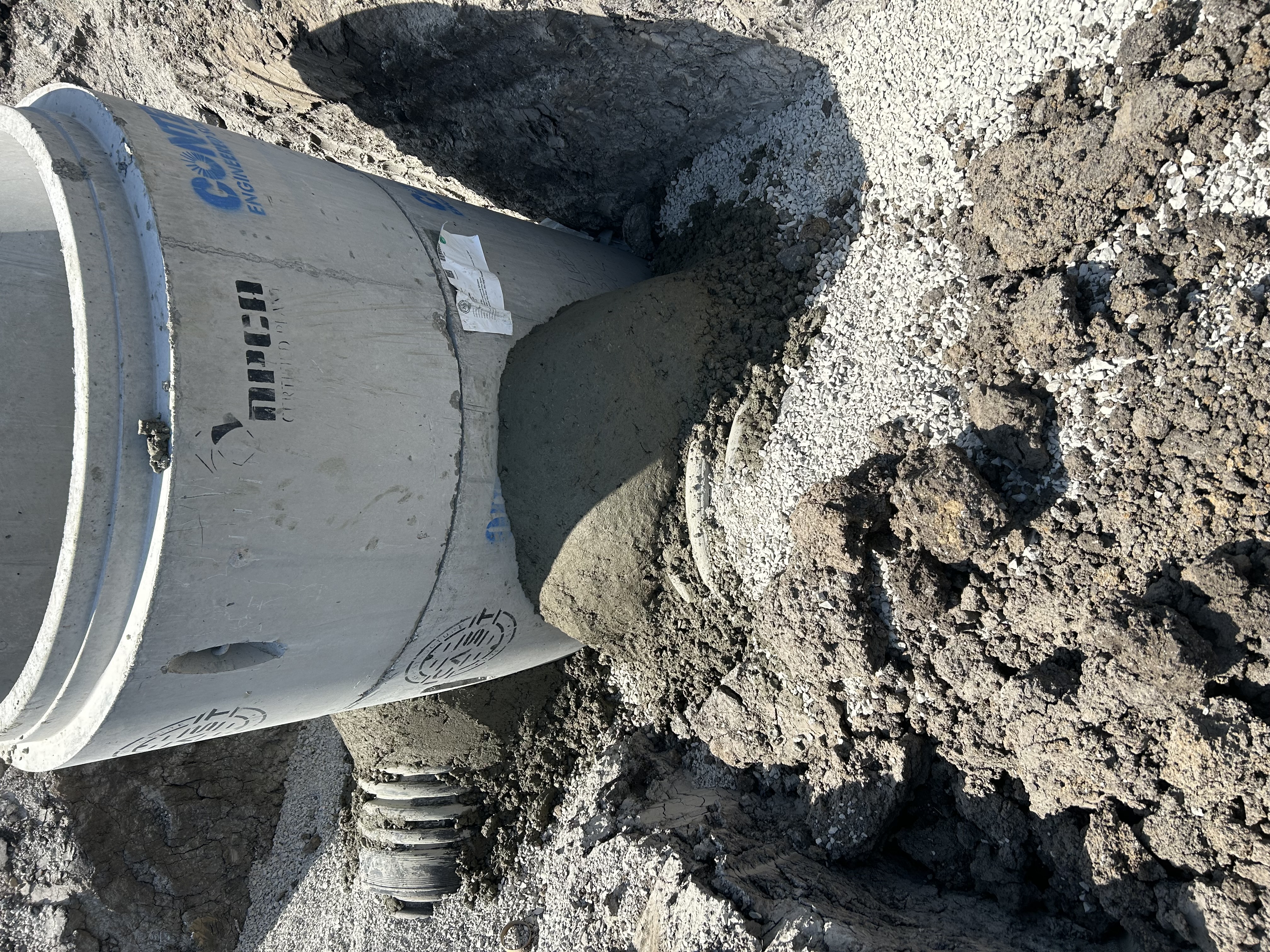

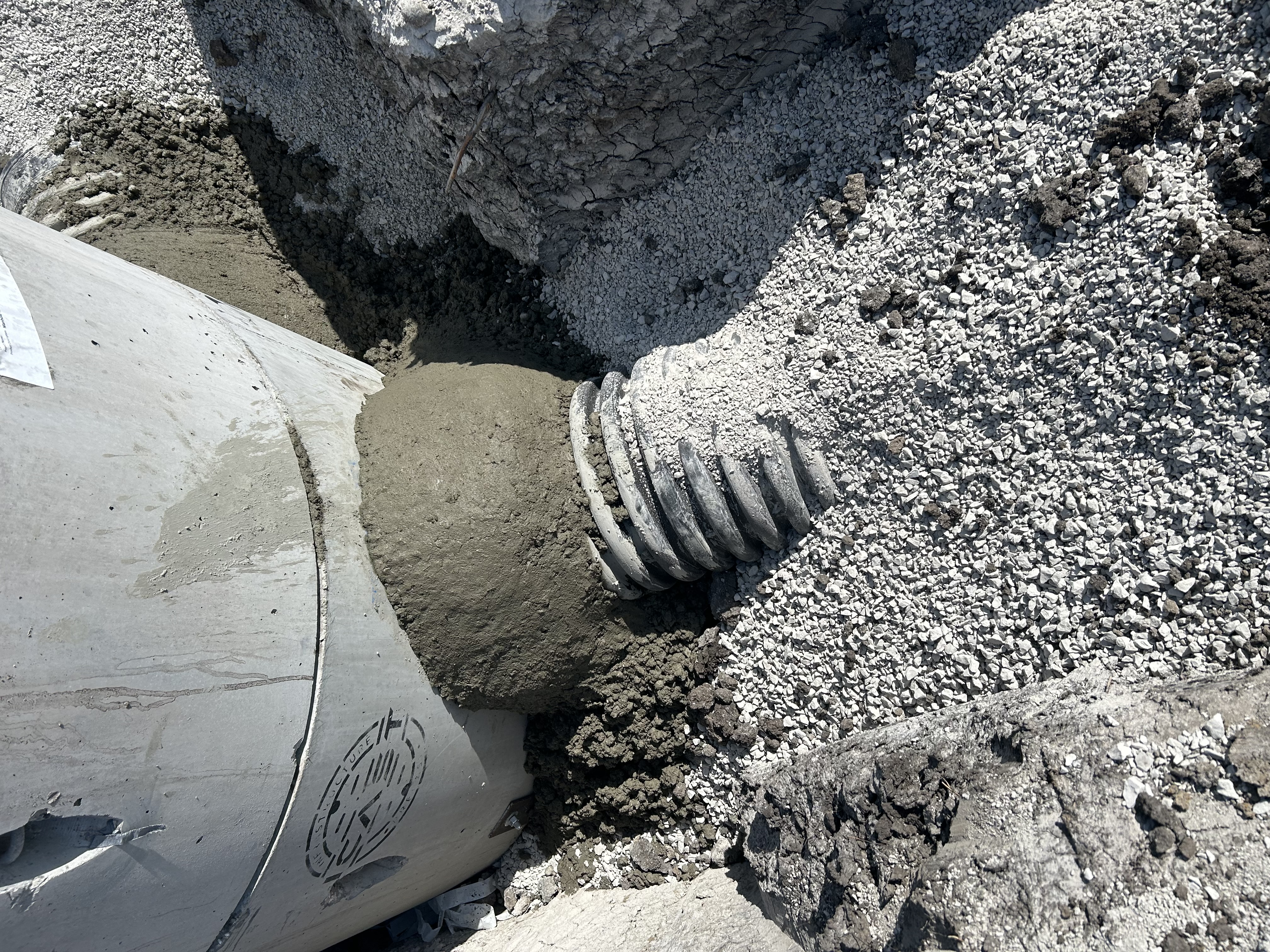

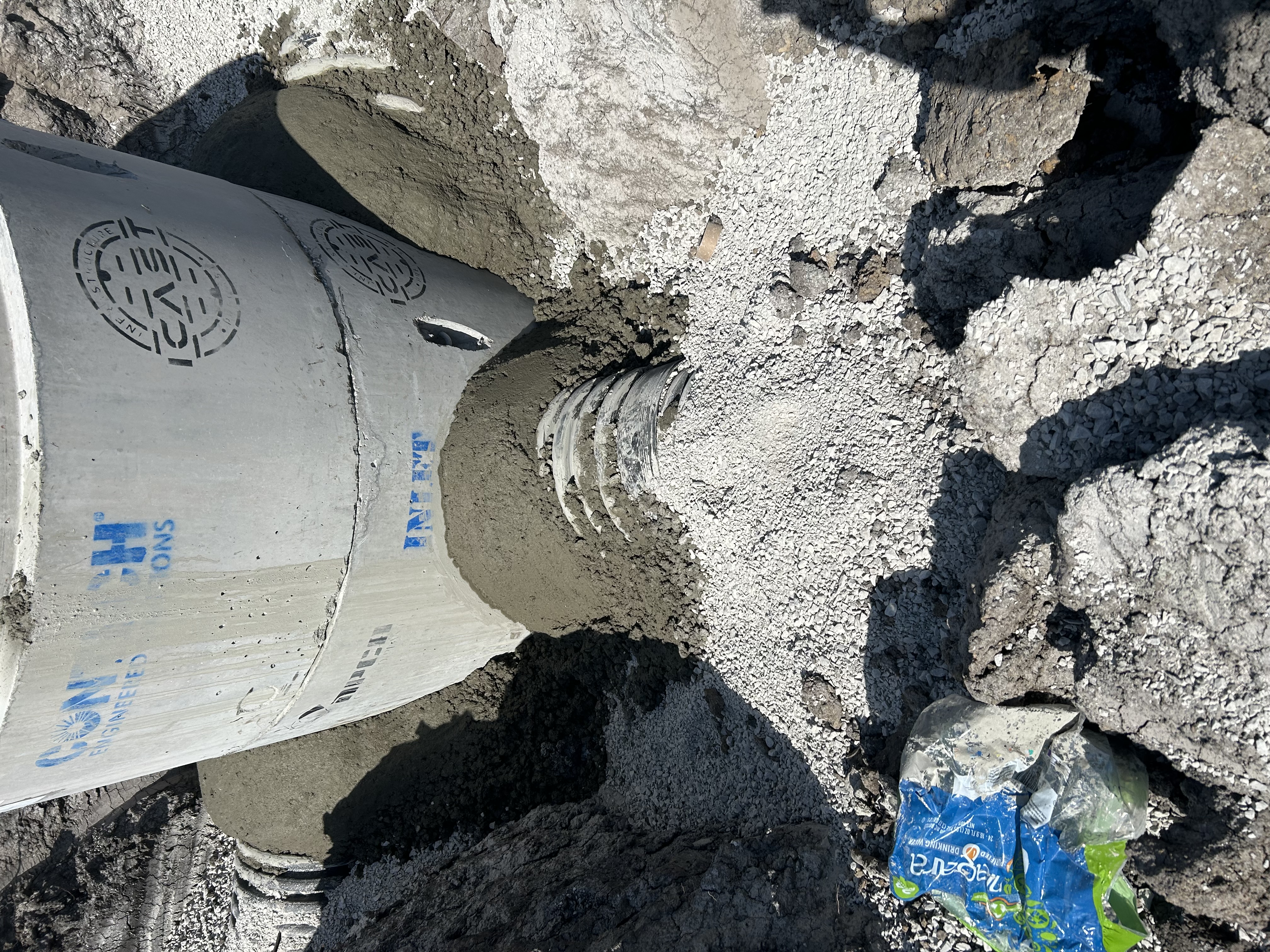

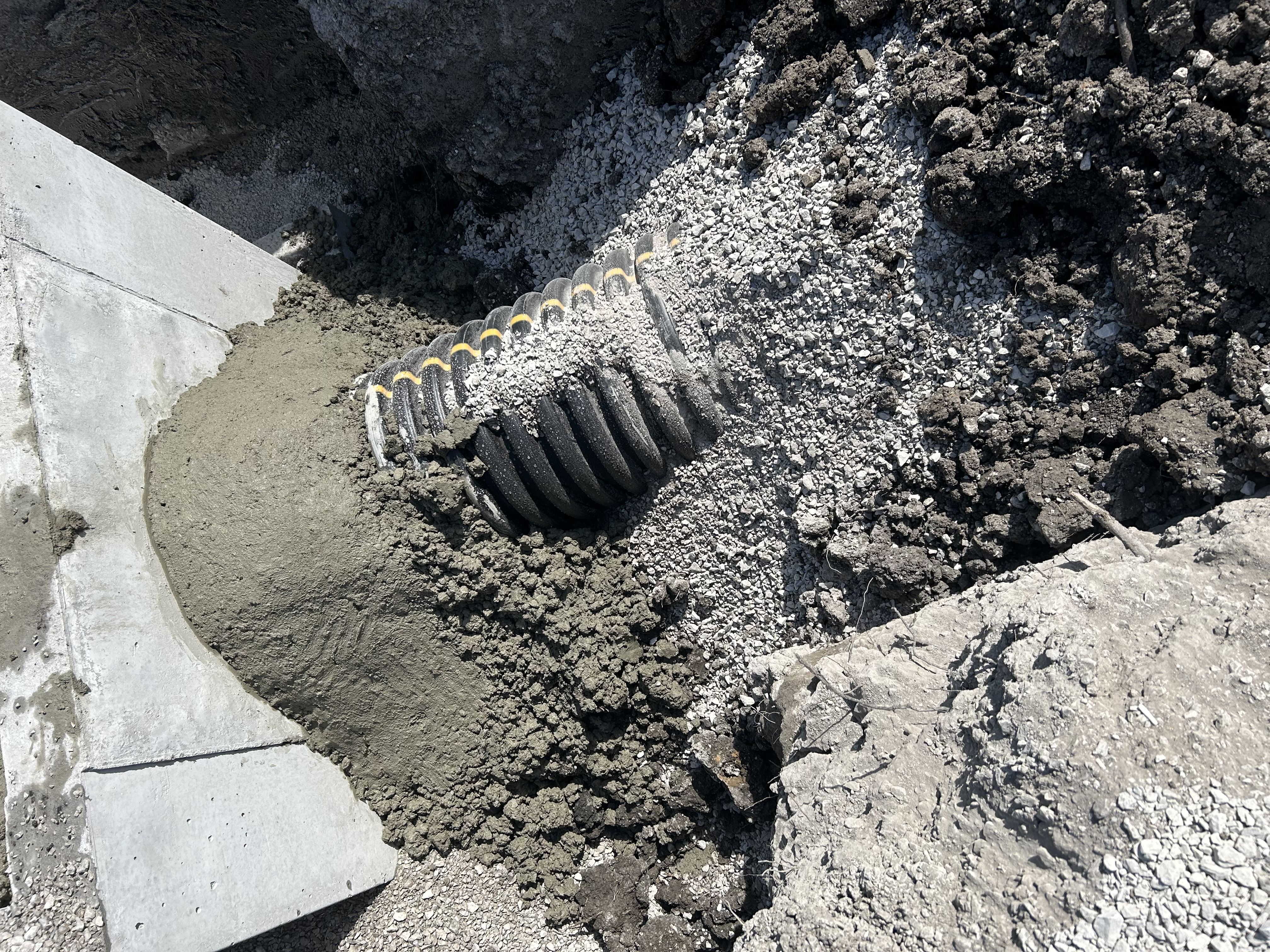

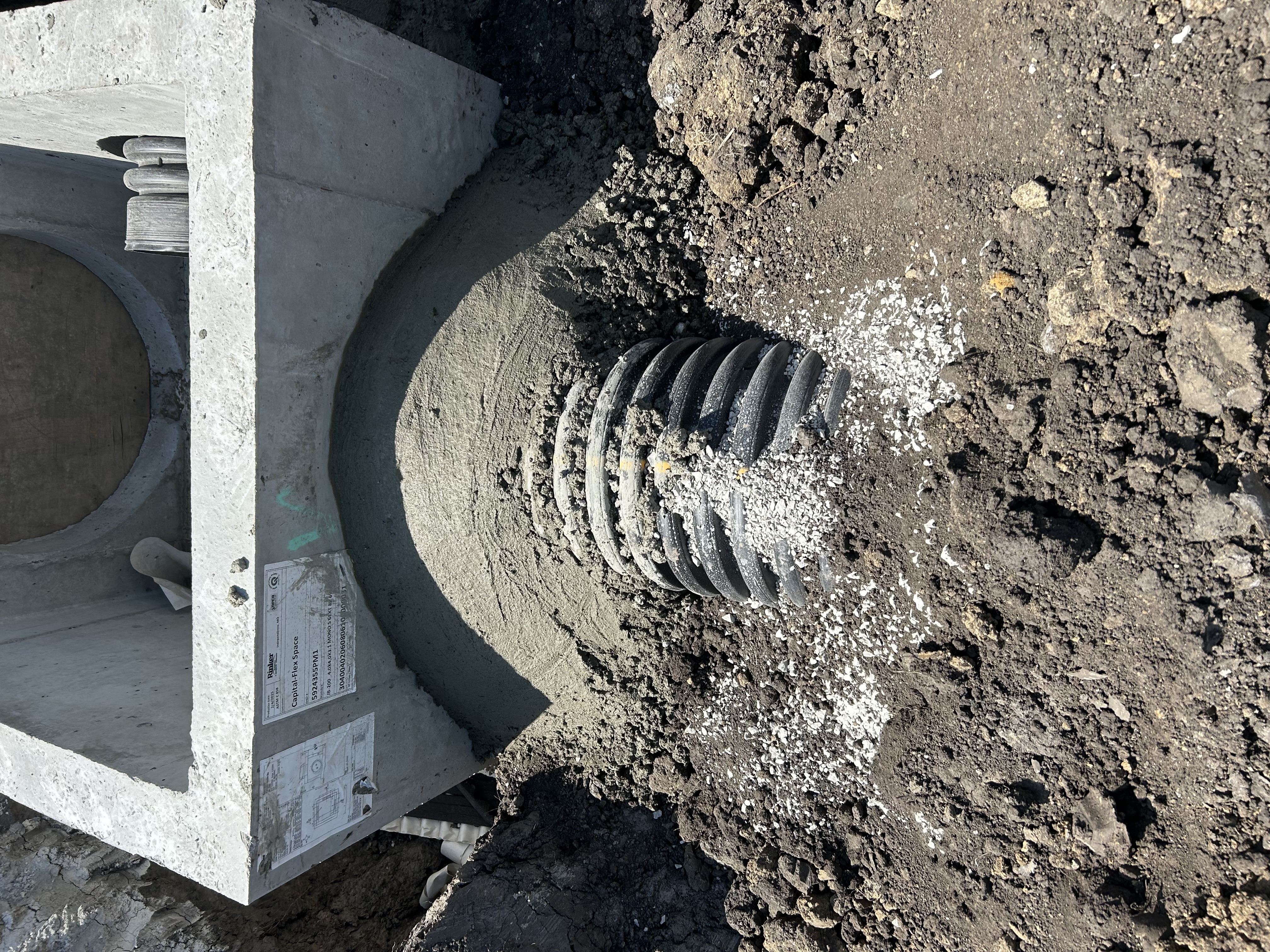

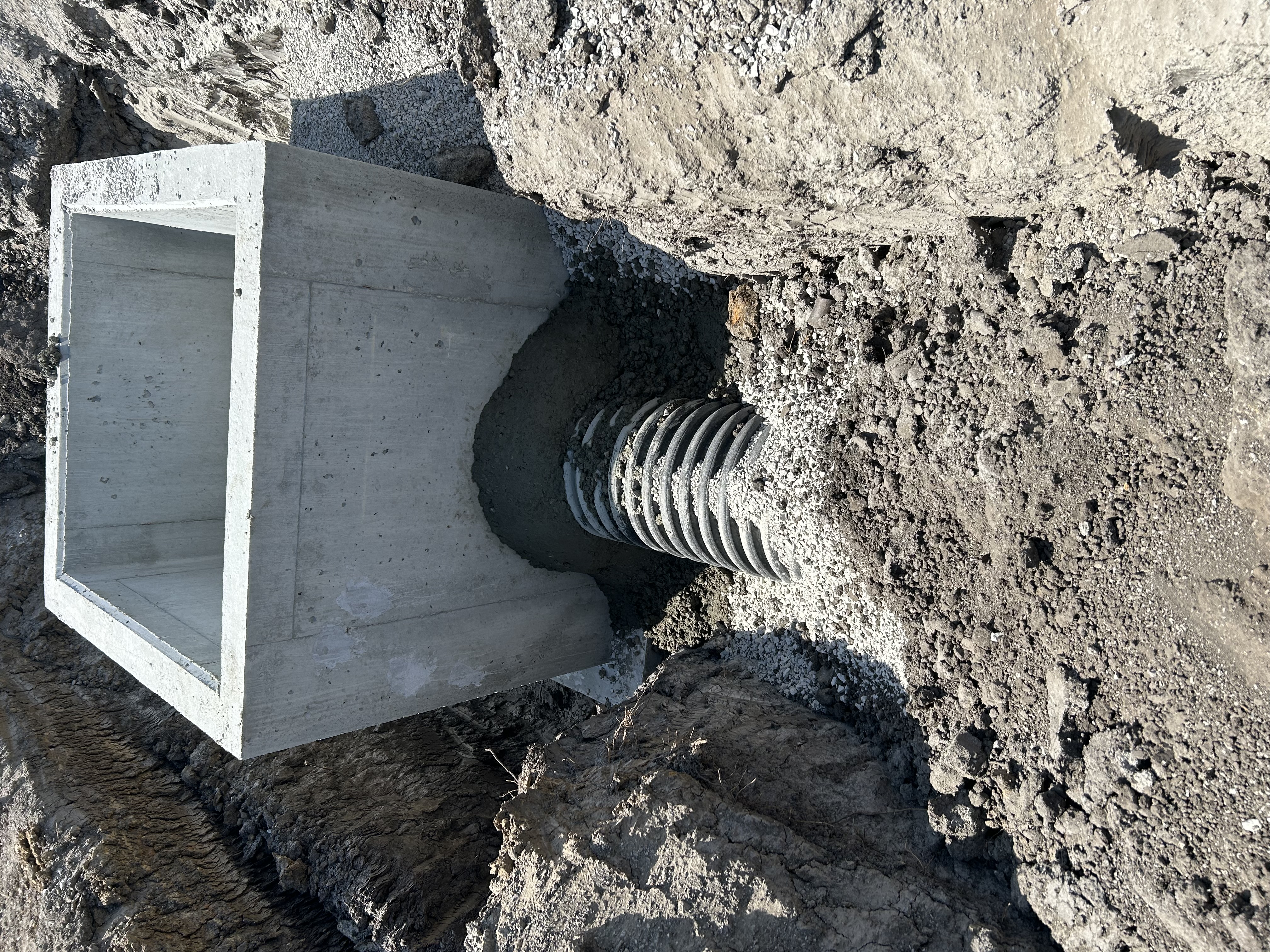

8-1-25 Dustin A, East approach is formed and compacted. Approved to pour
Grading/Excavation/Fill Inspection Pending
Install Street and Stop Signs Pending
Footing Inspection - Commercial Pending
Misc
Informational
11/07/2024
Building footing inspected. -10/07/24
Underslab Plumbing Inspection - Commercial Pending
Misc
Informational
11/22/2024
UNDER SLAB PLUMBING APPROVED FOR SOUTH BUILDING (A) ONLY
Sidewalk Inspection Pending
Misc
Informational
07/14/2025
7-11-25 Dustin A, Sw is formed and compacted. Approved to pour. 7-14-25 Dustin A, Sw was reinspected due to rain. ADA ramp had to be dug out . Ada ramp was fixed approved to pour.
Sprinkler - Hydrostatic Test Pending
Sprinkler - Flow Test Pending
Site Visit Pending
Misc
Informational
08/22/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work 2-5-25 Dustin A, rain 2-24-25 Dustin A, Building work 3-13-25 Dustin A, building work 4-9-25 Dustin A, Pad site work
Occupancy Inspection - Codes Commercial Pending
Erosion Control Inspection Pending
Misc
Informational
11/05/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place 2-24-25 Dustin A, Erosion control is in place and maintained 4\9\25 Dustin A, Erosion control is in place 9-22-25 Dustin A, There is some silt fence down in areas, i have reached out for a updated Swppp report as well . Please have erosion control corrected in 2 business days 11-5-25 Dustin A, Sidewalks still have not been cleaned , Talked to Ryan with capital builders and said he would get it taken care of first thing in the morning . Informed me sod was coming this week as well
Occupancy Inspection - Engineering Pending
Miscellaneous Correction
Corrective Action Required
11/07/2025
Updated 11-7-25 PUNCH LIST ITEMS FOR FINAL 1. 75% Vegetation 2. All building material needs to be removed from site as well as stuff stored on empty lot across the street on Decker 3. Permanent hand rail needs to be installed per plans on sidewalk near storm water creek. 4. C-storm 1 manhole needs to be raised to grade 5 Needs graded 6. All trash need to be picked up . 7. Weeds needs to be cut down near meter pit and through out site 8. Must maintain Erosion Control until vegetation is established . 9. Valve for hydrant is missing 10. Drain for valve still needs to be cut back
Occupancy Inspection - Planning Pending 8/29/2025
Misc
Corrective Action Required
08/25/2025
Complete landscaping and vegetation per approved landscape plan.
Occupancy Inspection - Fire Pending 8/29/2025
Erosion Control Inspection Residential Partial 9/23/2024 9/23/2024 09/23/2024
Misc
Informational
09/23/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today.
Erosion Control Inspection Partial 9/26/2024 9/26/2024 09/26/2024
Misc
Informational
09/26/2024
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence.
Erosion Control Inspection Residential Partial 10/16/2024 10/16/2024 10/16/2024
Misc
Informational
09/23/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go
Site Visit Failed 10/23/2024
Misc
Informational
10/23/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow
Erosion Control Inspection Residential Failed 10/24/2024 10/24/2024 10/24/2024
Misc
Informational
10/16/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go
DCM3 ESC REQUIRED 2 DAY
Corrective Action Required
10/24/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS.
Site Visit Partial 10/25/2024
Misc
Informational
10/23/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent,
Erosion Control Inspection Residential Partial 10/28/2024 10/28/2024 10/28/2024
Misc
Informational
10/24/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go
DCM3 ESC REQUIRED 2 DAY
Corrective Action Required
10/24/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
Site Visit Partial 10/30/2024
Misc
Informational
10/25/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done
Erosion Control Inspection Residential Partial 11/5/2024 11/5/2024 11/05/2024
Misc
Informational
10/28/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place
DCM3 ESC REQUIRED 2 DAY
Informational
11/05/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out build 11-5-24 Dustin A, Erosion control in place. 11-14-24 Dustin A, Section of silt fence taken down. Informed justin it needed corrected. 11-20-24 Dustin A, Silt fence is in working order 11-27-24 Dustin A, Aspire has silt fence down to put in gas line 12--24 Dustin A, Silt fence need reestablished where aspire was. Talked with justin and Bair i supposed to be out this week
Site Visit Partial 11/05/2024
Misc
Informational
10/30/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work
Site Visit Partial 11/7/2024 11/7/2024 11/07/2024
Misc
Informational
11/05/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance
Footing Inspection - Commercial Partial 11/7/2024 11/7/2024 11/07/2024
Misc
Informational
11/07/2024
Building footing inspected. -10/07/24
Site Visit Partial 11/12/2024 11/12/2024 11/12/2024
Misc
Informational
11/07/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work
Underslab Plumbing Inspection - Commercial Partial 11/22/2024 11/22/2024
Misc
Informational
11/22/2024
UNDER SLAB PLUMBING APPROVED FOR SOUTH BUILDING (A) ONLY
Sewer Service Inspection Partial 11/26/2024 11/26/2024 11/26/2024
Misc
Informational
11/22/2024
11-26-24 Dustin A, Met with Dan on site to go over plans for tie in. Will probably tie in sewer tomorrow
Sewer Service Inspection Partial 11/27/2024 11/27/2024 11/27/2024
Misc
Informational
11/26/2024
11-26-24 Dustin A, Met with Dan on site to go over plans for tie in. Will probably tie in sewer tomorrow 11-27-24 Dustin A, Performed sewer tie in. Installed y and 14 ft sewer stub. Will possibly lay rest of lateral
Site Visit Partial 12/10/2024 12/10/2024 12/10/2024
Misc
Informational
11/12/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us
Site Visit Partial 12/11/2024 12/11/2024 12/11/2024
Misc
Informational
12/10/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt
Erosion Control Inspection Residential Partial 12/11/2024 12/11/2024 12/11/2024
Misc
Informational
11/05/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place 12-11-24 Dustin A, Erosion control is in place and is in compliance
DCM3 ESC REQUIRED 2 DAY
Informational
11/05/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
Site Visit Partial 12/11/2024
Misc
Informational
12/11/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils
Erosion Control Inspection Residential Partial 12/12/2024 12/12/2024 12/12/2024
Misc
Informational
12/11/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place 12-11-24 Dustin A, Erosion control is in place and is in compliance 12-12-24 Dustin A, Talked to Dan about second construction entrance.
DCM3 ESC REQUIRED 2 DAY
Informational
12/11/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
Site Visit Partial 12/13/2024 12/13/2024 12/13/2024
Misc
Informational
12/11/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us
Site Visit Partial 12/17/2024 12/17/2024 12/17/2024
Misc
Informational
12/13/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing
Site Visit Partial 12/27/2024 12/27/2024 12/27/2024
Misc
Informational
12/17/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site
Site Visit Partial 01/13/2025
Misc
Informational
12/27/2024
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow
Erosion Control Inspection Residential Failed 01/31/2025
Misc
Informational
12/12/2024
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place 12-11-24 Dustin A, Erosion control is in place and is in compliance 12-12-24 Dustin A, Talked to Dan about second construction entrance.
DCM3 ESC REQUIRED 2 DAY
Informational
12/12/2024
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
DCM3 ESC REQUIRED 2 DAY
Informational
01/31/2025
1-31-25 Dustin A, silt fence down in several areas. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS.
Site Visit Partial 1/31/2025 1/31/2025 01/31/2025
Misc
Informational
01/13/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work
Erosion Control Inspection Failed 1/31/2025 1/31/2025 01/31/2025
Misc
Informational
09/26/2024
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out.
Site Visit Partial 2/4/2025 2/4/2025 02/04/2025
Misc
Informational
01/31/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work
Erosion Control Inspection Partial 02/04/2025
Misc
Informational
01/31/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place
Erosion Control Inspection Residential Partial 2/4/2025 2/4/2025 02/04/2025
Misc
Informational
01/31/2025
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place 12-11-24 Dustin A, Erosion control is in place and is in compliance 12-12-24 Dustin A, Talked to Dan about second construction entrance.
DCM3 ESC REQUIRED 2 DAY
Informational
01/31/2025
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
DCM3 ESC REQUIRED 2 DAY
Informational
01/31/2025
1-31-25 Dustin A, silt fence down in several areas. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 2-4-25 Dustin A, Silt fence is corrected
Site Visit Partial 2/5/2025 2/5/2025 02/05/2025
Misc
Informational
02/04/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work 2-5-25 Dustin A, rain
Site Visit Partial 02/24/2025
Misc
Informational
02/05/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work 2-5-25 Dustin A, rain 2-24-25 Dustin A, Building work
Erosion Control Inspection Partial 2/24/2025 2/24/2025 02/24/2025
Misc
Informational
02/04/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place 2-24-25 Dustin A, Erosion control is in place and maintained
Site Visit Partial 03/13/2025
Misc
Informational
02/24/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work 2-5-25 Dustin A, rain 2-24-25 Dustin A, Building work 3-13-25 Dustin A, building work
Erosion Control Inspection Partial 04/09/2025
Misc
Informational
02/24/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place 2-24-25 Dustin A, Erosion control is in place and maintained 4\9\25 Dustin A, Erosion control is in place
Site Visit Partial 4/9/2025 4/9/2025 04/09/2025
Misc
Informational
03/13/2025
10-23-24 Dustin A , Talked with jared on erosion control. They are removing the rest of the brush today and gordon is scheduled to come out tomorrow 10-24-24 Dustin A, Erosion control on north side is still absent, 10-30-24 Dustin A, Pad site work being done 11-5-24 Dustin A, footing work 11-7-24 Dustin A, footing work , rip out curb to make a construction entrance 11-12-24 Dustin A, Footing work 12-10-24 Dustin A, no work for us 12-11-24 Jamie S, on site contractor hauling off dirt 12-11-24 Dustin A, Hauling off spoils 12-13-24 Dustin A, no work for us 12-17-24 Dustin A, Footing work for second builing 12-27-24 Dustin A, Nobody on site 1-13-25 Dustin A. Nobody on site due to cold and snow 1-31-25 Dustin A, rain. building work 2-4-25 Dustin A, no work 2-5-25 Dustin A, rain 2-24-25 Dustin A, Building work 3-13-25 Dustin A, building work 4-9-25 Dustin A, Pad site work
Site Visit Partial 04/18/2025
Misc
Informational
04/18/2025
4-18-25 Dustin A, working on storm
Site Visit Partial 04/23/2025
Misc
Informational
04/18/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled.
Erosion Control Inspection Residential Partial 04/23/2025
Misc
Informational
02/04/2025
9-23-24 BR Spoke with Matt Hendrickson about getting silt fence up and in place do to them grading area on today. 10-16-24 Dustin A, Talked with jared about silt fence down, Their removing some trees and will replace as they go 11-5-24 Dustin A, Erosion control in place 12-11-24 Dustin A, Erosion control is in place and is in compliance 12-12-24 Dustin A, Talked to Dan about second construction entrance.
DCM3 ESC REQUIRED 2 DAY
Informational
02/04/2025
10-24-24 Dustin A, Gordon has not showed up to install. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 10-28-24 Dustin A, Silt fence has been fixed. Must be maintained through out buid
DCM3 ESC REQUIRED 2 DAY
Informational
02/04/2025
1-31-25 Dustin A, silt fence down in several areas. EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. 2-4-25 Dustin A, Silt fence is corrected 4-23-25 Dustin A, silt fence is all intact and is fuctioning
Site Visit Partial 5/15/2025 5/15/2025 05/15/2025
Misc
Informational
04/23/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set,
Erosion Control Inspection Partial 05/15/2025
Misc
Informational
05/15/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned
Site Visit Partial 5/16/2025 5/16/2025 05/16/2025
Misc
Informational
05/15/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line.
Fire Line - Hydrostatic Test Passed 6/2/2025 6/2/2025 06/02/2025
Misc
Informational
06/02/2025
6-2-25 Dustin A, Fire line was hydrostatic tested and held for 2 hours. pass
Fire Line - Hydrostatic Test Passed 06/12/2025
Misc
Informational
06/12/2025
6-2-25 Hydrostatic test of fire line performed. Line held 200 psi for 2 hours. Hydrostatic passed city requirements.
Fire Line Construction Inspection Passed 06/12/2025
Misc
Informational
06/12/2025
5-30-25 Dustin A, 155 ft of fire line is installed from T to inside building
Site Visit Partial 6/17/2025 6/17/2025 06/17/2025
Misc
Informational
05/16/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line. 6-17-25 Dustin A, Working on removing mud and prepping for drive
Erosion Control Inspection Partial 5/29/2025 5/29/2025 06/24/2025
Misc
Informational
05/15/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected
Water Line - Construction Inspection Passed 06/27/2025
Misc
Informational
06/27/2025
6-11 -25 Dustin A, Fire line has passed chlorination, hydrostatic tests. Line was was flushed for min of 3 hrs /
In-wall Inspection Failed 7/3/2025 07/03/2025
Misc
Corrective Action Required
07/03/2025
NOT A COMPLETE INSPECTION Provide address -remove insulation -remove drywall -secure and complete all electrical -protect all plumbing within 1.25” of face framing -separation walls framed 24” OC plans call for 16” OC -provide blocking for grab bars
Erosion Control Inspection Failed 07/07/2025
Misc
Informational
06/24/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware
Erosion Control Inspection Failed 7/8/2025 7/8/2025 07/08/2025
Misc
Informational
07/07/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued.
In-wall Inspection Not Ready 7/9/2025 7/9/2025 07/09/2025
Misc
Corrective Action Required
07/09/2025
Not ready for inspection NOT A COMPLETE INSPECTION -remove insulation and drywall where covering inspection items -secure and complete all electrical -protect all plumbing within 1.25” of face framing -separation walls framed 24” OC plans call for 16” OC
Above Ceiling Inspection Failed 7/9/2025 7/9/2025 07/09/2025
Miscellaneous Correction
Corrective Action Required
07/09/2025
NOT A COMPLETE INSPECTION -secure and complete all electrical in all units -complete bath fan installation
Sidewalk Inspection Partial 07/11/2025
Misc
Informational
07/11/2025
7-11-25 Dustin A, Sw is formed and compacted. Approved to pour.
Sewer Service Inspection Passed 07/11/2025
Misc
Informational
11/27/2024
11-26-24 Dustin A, Met with Dan on site to go over plans for tie in. Will probably tie in sewer tomorrow 11-27-24 Dustin A, Performed sewer tie in. Installed y and 14 ft sewer stub. Will possibly lay rest of lateral
Erosion Control Inspection Partial 7/11/2025 7/11/2025 07/11/2025
Misc
Informational
07/08/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected
Above Ceiling Inspection Failed 7/14/2025 7/14/2025 07/14/2025
Misc
Corrective Action Required
07/14/2025
Complete bath fan venting
In-wall Inspection Passed 7/14/2025 7/14/2025 07/14/2025
Misc
Resolved
07/14/2025
Not ready for inspection NOT A COMPLETE INSPECTION -remove insulation and drywall where covering inspection items -secure and complete all electrical -protect all plumbing within 1.25” of face framing -separation walls framed 24” OC plans call for 16” OC
Sidewalk Inspection Partial 7/18/2025 7/18/2025 07/14/2025
Misc
Informational
07/11/2025
7-11-25 Dustin A, Sw is formed and compacted. Approved to pour. 7-14-25 Dustin A, Sw was reinspected due to rain. ADA ramp had to be dug out . Ada ramp was fixed approved to pour.
Erosion Control Inspection Partial 7/14/2025 7/14/2025 07/14/2025
Misc
Informational
07/11/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected 7-14-25 Dustin A, Talked with Jason and Ryan on some silt fence being down along thompson and in front of storm inlet.
Site Visit Partial 7/18/2025 7/18/2025 07/21/2025
Misc
Informational
06/17/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line. 6-17-25 Dustin A, Working on removing mud and prepping for drive 7-18-25 Dustin A, Building work, prepping for proof roll
Erosion Control Inspection Partial 7/18/2025 7/18/2025 07/21/2025
Misc
Informational
07/14/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected 7-14-25 Dustin A, Talked with Jason and Ryan on some silt fence being down along thompson and in front of storm inlet. 7-18-25 Dustin A, Silt fence was down near a storm inlet, Discussed it with ryan and he said he would get it taken care of.
Pavement-Proof Roll Partial 07/21/2025
Misc
Informational
07/21/2025
4-21-25 Dustin A, prepping for proof roll. Canceled due to rain.
Above Ceiling Inspection Failed 7/23/2025 7/23/2025 07/23/2025
Misc
Corrective Action Required
07/14/2025
Not a complete list -Complete bath fan venting -secure all MC within 12” of boxes/termination points.
Above Ceiling Inspection Passed 7/24/2025 7/24/2025 07/24/2025
Misc
Resolved
07/24/2025
Not a complete list -Complete bath fan venting -secure all MC within 12” of boxes/termination points.
Erosion Control Inspection Partial 07/25/2025
Misc
Informational
07/21/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected 7-14-25 Dustin A, Talked with Jason and Ryan on some silt fence being down along thompson and in front of storm inlet. 7-18-25 Dustin A, Silt fence was down near a storm inlet, Discussed it with ryan and he said he would get it taken care of. 7-25-25 Dustin A, No work due to wet conditions
Erosion Control Inspection Partial 07/25/2025
Misc
Informational
07/25/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected 7-14-25 Dustin A, Talked with Jason and Ryan on some silt fence being down along thompson and in front of storm inlet. 7-18-25 Dustin A, Silt fence was down near a storm inlet, Discussed it with ryan and he said he would get it taken care of. 7-25-25 Dustin A, No work due to wet conditions
Pavement-Proof Roll Partial 07/29/2025
Misc
Informational
07/29/2025
7-28-25 Dustin A, proof roll performed, Sections on east side did not pass, 7-29-25 Dustin A, proof roll performed , Still sections did not pass 7-29-25 Dustin A, another proof roll performed. failing sections have passed. Approved to pour
Curb - Proof Roll Partial 7/29/2025 7/29/2025 07/29/2025
Misc
Informational
07/29/2025
7-29-25 Dustin A, curb line has been proof rolled and has passed at this time.
Electrical Service Inspection Failed 8/5/2025 8/5/2025 08/05/2025
Misc
Corrective Action Required
08/05/2025
-Provide address at main disconnect -remove paint at structural bond
Electrical Service Inspection Passed 8/6/2025 8/6/2025 08/06/2025
Site Visit Partial 08/06/2025
Misc
Informational
07/21/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line. 6-17-25 Dustin A, Working on removing mud and prepping for drive 7-18-25 Dustin A, Building work, prepping for proof roll 8-6-25 Dustin A, Nothing for development to look at
Site Visit Partial 8/11/2025 8/11/2025 08/11/2025
Misc
Informational
08/06/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line. 6-17-25 Dustin A, Working on removing mud and prepping for drive 7-18-25 Dustin A, Building work, prepping for proof roll 8-6-25 Dustin A, Nothing for development to look at 8/11/25 Tyler S. No work for DEV due to rain.
Curb - Proof Roll Passed 08/18/2025
Misc
Informational
07/29/2025
7-29-25 Dustin A, curb line has been proof rolled and has passed at this time.
Pavement-Aggregate Base Passed 08/18/2025
Pavement-Curb Construction Passed 08/18/2025
Pavement-Curb Construction Passed 08/18/2025
Miscellaneous Correction
Informational
07/30/2025
7-30-25 Dustin A, Working on curb
Pavement-Stabilized Subgrade Passed 08/18/2025
Pavement-Proof Roll Passed 08/18/2025
Misc
Informational
07/29/2025
7-28-25 Dustin A, proof roll performed, Sections on east side did not pass, 7-29-25 Dustin A, proof roll performed , Still sections did not pass 7-29-25 Dustin A, another proof roll performed. failing sections have passed. Approved to pour 8-18-25 Dustin A, Proof roll for surface passed
Storm Sewer Construction Inspection Passed 08/18/2025
Water Line - Hydrostatic Test Passed 08/18/2025
Misc
Informational
08/18/2025
Water line passed hydrostatic test
Water Line - Coliform Test 1 Passed 08/18/2025
Water Line - Coliform Test 2 Passed 08/18/2025
Erosion Control Inspection Partial 08/20/2025
Misc
Informational
07/25/2025
5-15-25 Dustin A, Esc is in place. Addressed a issue along creek line and it is being corrected. Road needs to be cleaned 6-24-25 Dustin A, There is some silt fence down in areas, talked with contractor and will be corrected 7-7-25 Dustin A. Silt fence down and restrooms need to be removed from street. Talked with Matt and he is aware 7-8-25 Dustin A, Erosion control is still down storm inlets are not protected and restrooms are STILL out on public street. This is a 2 DAY NOTICE. Failure to correct these issues by 7-10 will result in a STOP WORK ORDER issued 7-11-25 Dustin A, Issue corrected 7-14-25 Dustin A, Talked with Jason and Ryan on some silt fence being down along thompson and in front of storm inlet. 7-18-25 Dustin A, Silt fence was down near a storm inlet, Discussed it with ryan and he said he would get it taken care of. 7-25-25 Dustin A, No work due to wet conditions 8-20-25 Dustin A. Talked with ryan on some silt fence that is down . Informed him has to be maintained until veg is established
Site Visit Partial 08/22/2025
Misc
Informational
08/11/2025
4-18-25 Dustin A, working on storm 4-22-25 Dustin A, No work for us being done 4-23-25 Dustin A, all storm is laid. Boxes are set. Collars are poured and flow fill poured and backfilled. 5-15-25 Dustin A, Building work being done. Water vault is set, 5-16-25 Dustin A, Working on service line. 6-17-25 Dustin A, Working on removing mud and prepping for drive 7-18-25 Dustin A, Building work, prepping for proof roll 8-6-25 Dustin A, Nothing for development to look at 8/11/25 Tyler S. No work for DEV due to rain. 8-22-25 Dustin A, Building work being done to get TCO
Occupancy Inspection - Planning Temporary C of O 8/25/2025 08/25/2025
Misc
Corrective Action Required
08/25/2025
Complete landscaping and vegetation per approved landscape plan.
Occupancy Inspection - Engineering Temporary C of O 8/25/2025 08/25/2025
Miscellaneous Correction
Corrective Action Required
08/25/2025
8-25-25 Dustin A, PUNCH LIST ITEMS FOR FINAL 1. 75% Vegetation 2. All building material needs to be removed from site as well as stuff stored on empty lot across the street on Decker 3. Permanent hand rail needs to be installed per plans on sidewalk near storm water creek. 4. Brush that was cut out for sidewalk was thrown into creek and will need to be removed. 6. Semi trailer needs to be removed. 7. Restrooms need to be removed. 8. C-storm 1 manhole needs to be raised to grade 9. Needs graded 10. All trash need to be picked up . 11. Weeds needs to be cut down near meter pit and through out site 12. Must maintain Erosion Control until vegetation is established .
Occupancy Inspection - Fire Failed 8/25/2025 08/25/2025
Occupancy Inspection - Water Utilities Passed 8/25/2025 08/26/2025
Occupancy Inspection - Codes Commercial Ready for Temp CO 8/25/2025 08/27/2025
Misc
Corrective Action Required
08/25/2025
-provide visible illuminated address -label all A/c disconnects -provide special inspection reports -provide provide engineer report for footing at main disconnect where chipped away to install ufer -provide 1 1/2” clearance at all grab bars -gfci protection for outlets in all bathrooms 8 -grab bars in bathroom do not meet ada requirements -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” -bathroom signage to be installed on the latching side of the bathroom door -gfci protection for receptacle in bathroom -toilet flush valve is to be on the accessible side of toilet 7 -gfci protection for receptacle in bathroom -bathroom signage to be installed on the latching side of the bathroom door -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” -grab bars in bathroom do not meet Ada requirements 6 -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” -toilet 19” off wall to center -bathroom signage to be installed on the latching side of the bathroom door -grab bars in bathroom do not meet Ada requirements 5 -bathroom signage to be installed on the latching side of the bathroom door -Unable to inspect bathroom being used as storage 4 -bathroom signage to be installed on the latching side of the bathroom door -grab bars not set to Ada specifications -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” - 3 -bathroom signage to be installed on the latching side of the bathroom door -grab bars not installed -toilet flush valve is to be on the accessible side of toilet -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” -open junction box above sink - 2 -bathroom signage to be installed on the latching side of the bathroom door -grab bars in bathroom do not meet ada requirements -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” 1 -bathroom signage to be installed on the latching side of the bathroom door -toilet flush valve is to be on the accessible side of toilet -toilet to be set 16”-18” off the side wall -grab bars in bathroom do not meet ada requirements -bottom edge of reflective surfaces for mirror in bathroom not to exceed 40” -threshold at entry over 1/4” change in elevation
Occupancy Inspection - Engineering Temporary C of O 8/29/2025 08/29/2025
Miscellaneous Correction
Corrective Action Required
08/25/2025
8-25-25 Dustin A, Updated 8-29-25 PUNCH LIST ITEMS FOR FINAL 1. 75% Vegetation 2. All building material needs to be removed from site as well as stuff stored on empty lot across the street on Decker 3. Permanent hand rail needs to be installed per plans on sidewalk near storm water creek. 6. Semi trailer needs to be removed. 7. Restrooms need to be removed. 8. C-storm 1 manhole needs to be raised to grade 9. Needs graded 10. All trash need to be picked up . 11. Weeds needs to be cut down near meter pit and through out site 12. Must maintain Erosion Control until vegetation is established .
Occupancy Inspection - Codes Commercial Failed 8/29/2025 08/29/2025
Misc
Corrective Action Required
08/25/2025
All units -grab bars on side of toilets to be to meet accountability requirements -provide nonabsorbent base 4” tall (1209.2.1) -provide nonabsorbent surface in bathrooms 4’ high everywhere within 2’ of fixtures (1209.2.2) -adjust Ada signage 48”-60” to braille 3 -opening j box in unit 3 above sink in garage
Occupancy Inspection - Fire Passed 9/2/2025 09/03/2025
Occupancy Inspection - Codes Commercial Ready for Temp CO 9/2/2025 09/03/2025
Misc
Resolved
09/02/2025
All units -grab bars on side of toilets to be to meet accountability requirements -provide nonabsorbent base 4” tall (1209.2.1) -provide nonabsorbent surface in bathrooms 4’ high everywhere within 2’ of fixtures (1209.2.2) -adjust Ada signage 48”-60” to braille 3 -opening j box in unit 3 above sink in garage
Erosion Control Inspection Failed 09/23/2025
Misc
Informational
08/20/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place 2-24-25 Dustin A, Erosion control is in place and maintained 4\9\25 Dustin A, Erosion control is in place 9-22-25 Dustin A, There is some silt fence down in areas, i have reached out for a updated Swppp report as well . Please have erosion control corrected in 2 business days .
Occupancy Inspection - Codes Commercial Ready for Temp CO 09/26/2025
Site Visit Partial 10/1/2025 10/1/2025 10/01/2025
Misc
Informational
10/01/2025
10-1-25 Dustin A, Punchlist Items have not all been completed
Occupancy Inspection - Codes Commercial Ready for Temp CO 10/3/2025 10/03/2025
Occupancy Inspection - Codes Commercial Ready for Temp CO 10/27/2025
Erosion Control Inspection Failed 11/05/2025
Misc
Informational
09/23/2025
9-26-24 DP. The silt fence company was onsite when I drove by installing required silt fence. 1-31-25 Dustin A, silt fence down , 2 day notice sent out. 2-4-25 Dustin A, erosion control in place 2-24-25 Dustin A, Erosion control is in place and maintained 4\9\25 Dustin A, Erosion control is in place 9-22-25 Dustin A, There is some silt fence down in areas, i have reached out for a updated Swppp report as well . Please have erosion control corrected in 2 business days 11-5-25 Dustin A, Sidewalks still have not been cleaned , Talked to Ryan with capital builders and said he would get it taken care of first thing in the morning . Informed me sod was coming this week as well
Occupancy Inspection - Engineering Temporary C of O 11/07/2025
Miscellaneous Correction
Corrective Action Required
08/29/2025
Updated 11-7-25 PUNCH LIST ITEMS FOR FINAL 1. 75% Vegetation 2. All building material needs to be removed from site as well as stuff stored on empty lot across the street on Decker 3. Permanent hand rail needs to be installed per plans on sidewalk near storm water creek. 4. C-storm 1 manhole needs to be raised to grade 5 Needs graded 6. All trash need to be picked up . 7. Weeds needs to be cut down near meter pit and through out site 8. Must maintain Erosion Control until vegetation is established . 9. Valve for hydrant is missing 10. Drain for valve still needs to be cut back
Documents & Images
Date Uploaded File Type Document Name
06/06/2024 Application Form APPLICATION
06/06/2024 Application Form EXCISE TAX FORM
06/21/2024 Plans 24-0606 Flex Warehouse Lee's Summit - Construction Documents
06/24/2024 Letter License Tax Bill
07/01/2024 Approved Plans Approved FDP Plan Set_LS Flex Space_PL2023332_05082024
07/02/2024 Approved Plans LS Flex Space Public Water Main Plans_Approved
07/03/2024 Letter Fire Building Plan Review
07/08/2024 Letter DS P/R Corrections Document
08/05/2024 Plans 24-0715 Flex Warehouse Lee's Summit - Construction Documents
08/05/2024 Letter 24-0715 Comments Response
08/05/2024 Plans 23-054_L001_Flex Space Landscape_240715
08/05/2024 3rd Party Permit/Approval Special Inspections
08/12/2024 Letter DS P/R Corrections Document
08/20/2024 Letter 24-0819 Comments Response
08/20/2024 Engineer Report/Study Flex Spaces SI
08/20/2024 Approved Plans Approved building permit set
09/09/2024 Receipt Receipt for transaction:2024-007545
09/11/2024 Letter old - DS Building Permit
09/13/2024 Letter DS Building Permit
09/23/2024 Letter INSPECTION SUMMARY
09/26/2024 Letter INSPECTION SUMMARY
10/16/2024 Letter INSPECTION SUMMARY
10/23/2024 Letter INSPECTION SUMMARY
10/23/2024 Letter INSPECTION SUMMARY
10/24/2024 Letter INSPECTION SUMMARY
10/24/2024 Letter INSPECTION SUMMARY
10/25/2024 Letter INSPECTION SUMMARY
10/28/2024 Letter INSPECTION SUMMARY
10/30/2024 Letter INSPECTION SUMMARY
11/05/2024 Letter INSPECTION SUMMARY
11/05/2024 Letter INSPECTION SUMMARY
11/07/2024 Letter INSPECTION SUMMARY
11/07/2024 Letter Fire Building Plan Review
11/07/2024 Letter Fire Building Plan Review
11/07/2024 Letter INSPECTION SUMMARY
11/07/2024 Letter Fire Building Plan Review
11/12/2024 Letter INSPECTION SUMMARY
11/21/2024 Approved Plans Approved Revised FDP Plan Set_PL2023322_11.21.2024_Admin
11/22/2024 Letter INSPECTION SUMMARY
11/26/2024 Letter INSPECTION SUMMARY
11/27/2024 Letter INSPECTION SUMMARY
12/10/2024 Letter INSPECTION SUMMARY
12/11/2024 Letter INSPECTION SUMMARY
12/11/2024 Letter INSPECTION SUMMARY
12/11/2024 Letter INSPECTION SUMMARY
12/11/2024 Letter INSPECTION SUMMARY
12/12/2024 Letter INSPECTION SUMMARY
12/13/2024 Letter INSPECTION SUMMARY
12/17/2024 Letter INSPECTION SUMMARY
12/18/2024 Approved Plans Approved Revised FDP Plan Set_PL2023322_12.18.2024
12/27/2024 Letter INSPECTION SUMMARY
01/13/2025 Letter INSPECTION SUMMARY
01/31/2025 Letter INSPECTION SUMMARY
01/31/2025 Letter INSPECTION SUMMARY
01/31/2025 Letter INSPECTION SUMMARY
01/31/2025 Letter INSPECTION SUMMARY
02/04/2025 Letter INSPECTION SUMMARY
02/04/2025 Letter INSPECTION SUMMARY
02/04/2025 Letter INSPECTION SUMMARY
02/04/2025 Letter INSPECTION SUMMARY
02/05/2025 Letter INSPECTION SUMMARY
02/24/2025 Letter INSPECTION SUMMARY
02/24/2025 Letter INSPECTION SUMMARY
02/24/2025 Letter INSPECTION SUMMARY
02/24/2025 Letter INSPECTION SUMMARY
03/13/2025 Letter INSPECTION SUMMARY
04/09/2025 Flex fdc
04/09/2025 flex fdc2
04/09/2025 Letter INSPECTION SUMMARY
04/09/2025 Letter INSPECTION SUMMARY

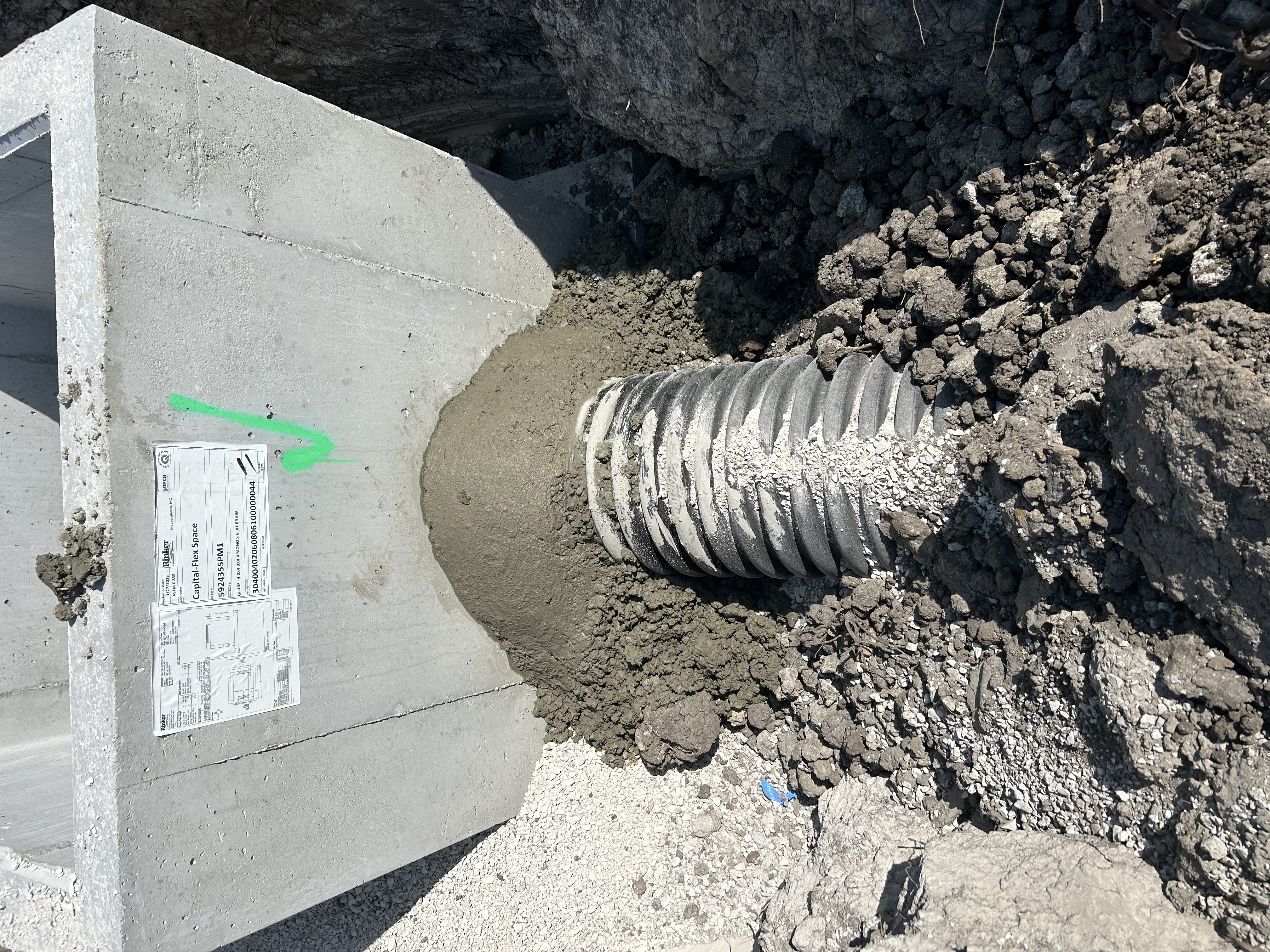

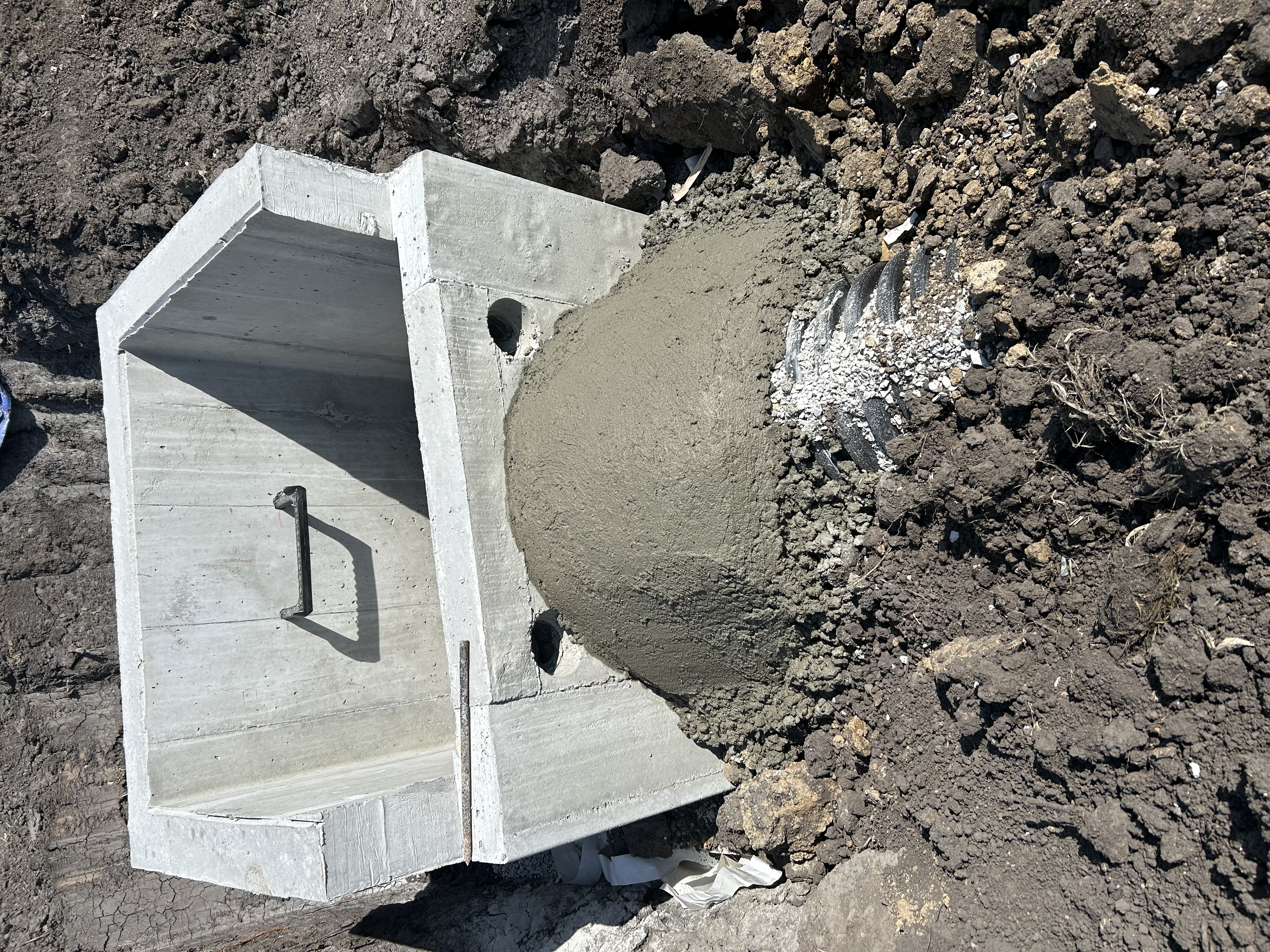

04/16/2025 Storm drain collar 004
04/16/2025 Storm drain collar 008
04/16/2025 Storm drain collar 009
04/16/2025 Storm drain collar 003
04/16/2025 Storm drain collar 002
04/16/2025 Storm drain collar 006
04/16/2025 Storm drain collar 007
04/16/2025 Storm drain collar 001
04/16/2025 Storm drain collar 005
04/16/2025 Storm drain collar 010
04/18/2025 Letter INSPECTION SUMMARY
04/23/2025 Letter INSPECTION SUMMARY
04/23/2025 Letter INSPECTION SUMMARY
04/23/2025 Letter INSPECTION SUMMARY
05/15/2025 Letter INSPECTION SUMMARY
05/15/2025 Letter INSPECTION SUMMARY
05/16/2025 Letter INSPECTION SUMMARY
06/02/2025 Letter INSPECTION SUMMARY
06/12/2025 Letter INSPECTION SUMMARY
06/12/2025 Letter INSPECTION SUMMARY
06/12/2025 Letter INSPECTION SUMMARY
06/17/2025 Letter INSPECTION SUMMARY
06/24/2025 Letter INSPECTION SUMMARY
06/27/2025 Letter INSPECTION SUMMARY
06/27/2025 Letter INSPECTION SUMMARY
07/03/2025 Letter INSPECTION SUMMARY
07/03/2025 Letter Fire Building Plan Review
07/07/2025 Letter INSPECTION SUMMARY
07/07/2025 Letter INSPECTION SUMMARY
07/08/2025 Letter INSPECTION SUMMARY
07/08/2025 Letter INSPECTION SUMMARY
07/09/2025 Letter INSPECTION SUMMARY
07/09/2025 Letter INSPECTION SUMMARY
07/11/2025 Letter INSPECTION SUMMARY
07/11/2025 Letter INSPECTION SUMMARY
07/11/2025 Letter INSPECTION SUMMARY
07/13/2025 FS LS - Updated stud spacing
07/14/2025 Letter INSPECTION SUMMARY
07/14/2025 Letter INSPECTION SUMMARY
07/14/2025 Letter INSPECTION SUMMARY
07/14/2025 Letter INSPECTION SUMMARY
07/21/2025 Letter INSPECTION SUMMARY
07/21/2025 Letter INSPECTION SUMMARY
07/21/2025 Letter INSPECTION SUMMARY
07/23/2025 Letter INSPECTION SUMMARY
07/24/2025 Letter INSPECTION SUMMARY
07/25/2025 Letter INSPECTION SUMMARY
07/25/2025 Letter INSPECTION SUMMARY
07/29/2025 Letter INSPECTION SUMMARY
07/29/2025 Letter INSPECTION SUMMARY
08/05/2025 Letter INSPECTION SUMMARY
08/06/2025 Letter INSPECTION SUMMARY
08/06/2025 Letter INSPECTION SUMMARY
08/11/2025 Letter INSPECTION SUMMARY
08/18/2025 Receipt Receipt for transaction:2025-006480
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 Letter INSPECTION SUMMARY
08/18/2025 flex watersmple1pass
08/18/2025 flexwatersample2pass
08/20/2025 Letter INSPECTION SUMMARY
08/22/2025 Letter INSPECTION SUMMARY
08/25/2025 Letter INSPECTION SUMMARY
08/25/2025 Letter INSPECTION SUMMARY
08/25/2025 Letter INSPECTION SUMMARY
08/25/2025 Letter Flex Spaces SI Final (1)
08/26/2025 Letter Gmail - RE_ Fire rated assemblies - Lees Summit
08/26/2025 Letter RFI - Gradebeam Demo - Repour - Garver Review
08/28/2025 Letter Backflow Test
08/28/2025 Receipt Receipt for transaction:2025-006764
08/29/2025 Letter INSPECTION SUMMARY
08/29/2025 Letter INSPECTION SUMMARY
08/29/2025 Letter INSPECTION SUMMARY
08/29/2025 Letter INSPECTION SUMMARY
08/29/2025 Letter INSPECTION SUMMARY
09/03/2025 Certificate/License Codes Temporary Certificate of Occupancy
09/03/2025 Receipt Receipt for transaction:2025-006861
09/23/2025 Letter INSPECTION SUMMARY
09/26/2025 Letter South Building Extension Form
10/01/2025 Letter INSPECTION SUMMARY
10/03/2025 Letter INSPECTION SUMMARY
10/27/2025 Letter South Building Extension Form_PRCOM20242901
10/27/2025 Certificate/License Codes Temporary Certificate of Occupancy
10/27/2025 Receipt Receipt for transaction:2025-008022
11/07/2025 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
