Permit Application Status

PRCOM20215300


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20215300
Building Permit - Commercial
Certificate of Occupancy
NEW COMMERCIAL
NEW COFFEE SHOP WITH DRIVE-THRU
10/11/2021
12/29/2021
04/30/2022
08/05/2022
Locations
Contacts
BEAR CONSTRUCTION SERVICES, Address:9218 METCALF #311, Phone:(913) 674-8004
Leland Hicks, Address:L.hicks@bearconstructionservices.com, Phone:(913) 238-0081
PRECISE ELECTRIC LLC, Address:3205 STEEL CIR, Phone:(816) 529-1799
INTEGRITY PLUMBING SERVICES LLC, Address:405 SW Nelson Dr., Phone:(816) 803-9032
CORALIC ARCHITECTURE, Address:9700 MACKENZIE RD, SUITE 217, Phone:(314) 578-4953
Mark Say, Address:BCSmarksay@gmail.com, Phone:(573) 410-9935
ATLAS MECHANICAL SERVICES INC, Address:26015 RA HWY, Phone:(913) 708-4695
Reviews
Review Type Outcome Est. Completion Date Completed
Building Plan Review Approved with Conditions 11/10/2021 12/02/2021
Mike Weisenborn
Health Dept Inspection
Corrective Action Required
11/03/2021

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 10/28/21 - not addressed 11/4/21 - acknowledged in letter
Engineered truss package
Corrective Action Required
11/03/2021

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide roof truss package or request deferral. 10/28/21 - not addressed 11/4/21 - acknowledged in letter
IBC 1803.1 General - geotech
Resolved
11/04/2021

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf. 10/28/21 - not found in submittal
IPC 604.8 Water pressure reducing valve
Resolved
11/04/2021

2018 IPC 604.8 Water Pressure reducing valve or regulator. Where water pressure within a building exceeds 80 psi static, an approved water-pressure reducing valve conforming to ASSE 1003 or CSA B356 with strainer shall be installed to reduce the pressure in the building water distribution piping to not greater than 80 psi static. Action required: Comment is for informational purposes. Water Department requires installation of PRV at all new water services. 10/28/21 - Notes still have "if" statement. PRV must be installed as our Water Department requires them for all new buildings. (the assumption being that pressures in our system are subject to change)
Final Development Plan
Resolved
12/02/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 10/28/21 - not addressed 11/4/21 - acknowledged in letter
Final Development Plan Review Approved 12/02/2021
Mike Weisenborn
Fire Plan Review Approved with Conditions 11/10/2021 11/03/2021
Michael Weissenbach
Address numbers required
Corrective Action Required
11/03/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Licensed Contractors Approved 11/10/2021 11/03/2021
Joe Frogge
Fire Plan Review Approved with Conditions 11/04/2021 10/28/2021
Michael Weissenbach
Address numbers required
Corrective Action Required
10/28/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Illumination required
Resolved
10/28/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Verified At Inspection) Provide exterior emergency lighting at the exit doors.
Building Plan Review Rejected 11/04/2021 10/28/2021
Joe Frogge
Health Dept Inspection
Corrective Action Required
10/28/2021

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 10/28/21 - not addressed
Engineered truss package
Corrective Action Required
10/28/2021

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide roof truss package or request deferral. 10/28/21 - not addressed
IBC 1803.1 General - geotech
Corrective Action Required
10/28/2021

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf. 10/28/21 - not found in submittal
Gen - Plan submittals 2018 codes
Resolved
10/28/2021

All plans submitted for review on or after April 1, 2019 shall be designed to the requirements of the 2018 International Building Code, 2018 International Mechanical Code, 2018 International Plumbing Code, 2018 International Fuel Gas Code, 2018 International Fire Code, 2017 National Electric Code and the ICC/ANSI A117.1-2009 as amended and adopted by the City of Lee’s Summit. Action required: Plans have been reviewed and will be inspection per 2018 I-series codes. Update code references on P3.0.
IPC 702.2 Underground building sanitary drainage and vent
Resolved
10/28/2021

2018 IPC 702.2 Underground building sanitary drainage and vent pipe. Underground building sanitary drainage and vent pipe shall conform to one of the standards listed in Table 702.2. -------------------------------------- 2018 IPC 702.1 Above-ground sanitary drainage and vent pipe. Above-ground soil, waste and vent pipe shall conform to one of the standards listed in Table 702.1. Action required: Specify waste/vent piping materials.
IPC 604.8 Water pressure reducing valve
Corrective Action Required
10/28/2021

2018 IPC 604.8 Water Pressure reducing valve or regulator. Where water pressure within a building exceeds 80 psi static, an approved water-pressure reducing valve conforming to ASSE 1003 or CSA B356 with strainer shall be installed to reduce the pressure in the building water distribution piping to not greater than 80 psi static. Action required: Comment is for informational purposes. Water Department requires installation of PRV at all new water services. 10/28/21 - Notes still have "if" statement. PRV must be installed as our Water Department requires them for all new buildings. (the assumption being that pressures in our system are subject to change)
Final Development Plan
Corrective Action Required
10/28/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 10/28/21 - not addressed
Licensed Contractors Approved 11/04/2021 10/28/2021
Joe Frogge
Licensed Contractors Approved 10/19/2021
Joe Frogge
LC - MEP Subs
Resolved
10/19/2021

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Building Plan Review Rejected 10/25/2021 10/19/2021
Joe Frogge
Health Dept Inspection
Corrective Action Required
10/19/2021

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes.
Engineered truss package
Corrective Action Required
10/19/2021

Copies of the engineered truss package were not provided at the time of permit application. Action required: Provide roof truss package or request deferral.
IBC 1803.1 General - geotech
Corrective Action Required
10/19/2021

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf.
Gen - Plan submittals 2018 codes
Corrective Action Required
10/19/2021

All plans submitted for review on or after April 1, 2019 shall be designed to the requirements of the 2018 International Building Code, 2018 International Mechanical Code, 2018 International Plumbing Code, 2018 International Fuel Gas Code, 2018 International Fire Code, 2017 National Electric Code and the ICC/ANSI A117.1-2009 as amended and adopted by the City of Lee’s Summit. Action required: Plans have been reviewed and will be inspection per 2018 I-series codes. Update code references on P3.0.
IPC 702.2 Underground building sanitary drainage and vent
Corrective Action Required
10/19/2021

2018 IPC 702.2 Underground building sanitary drainage and vent pipe. Underground building sanitary drainage and vent pipe shall conform to one of the standards listed in Table 702.2. -------------------------------------- 2018 IPC 702.1 Above-ground sanitary drainage and vent pipe. Above-ground soil, waste and vent pipe shall conform to one of the standards listed in Table 702.1. Action required: Specify waste/vent piping materials.
IPC 604.8 Water pressure reducing valve
Corrective Action Required
10/19/2021

2018 IPC 604.8 Water Pressure reducing valve or regulator. Where water pressure within a building exceeds 80 psi static, an approved water-pressure reducing valve conforming to ASSE 1003 or CSA B356 with strainer shall be installed to reduce the pressure in the building water distribution piping to not greater than 80 psi static. Action required: Comment is for informational purposes. Water Department requires installation of PRV at all new water services.
Final Development Plan
Corrective Action Required
10/19/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
Health Department Review Approved 10/18/2021
Joe Frogge
Fire Plan Review Approved with Conditions 10/25/2021 10/13/2021
Michael Weissenbach
Address numbers required
Corrective Action Required
10/13/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Illumination required
Corrective Action Required
10/13/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Verified At Inspection) Provide exterior emergency lighting at the exit doors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $1,700.00 $1,700.00 Paid 12/29/2021
8331507-Sewer Connection Fee $180.00 $180.00 Paid 12/29/2021
7232302-Commercial License Tax Fee $15,442.50 $15,442.50 Paid 12/29/2021
8331401-Water Tap Fee $9,750.00 $9,750.00 Paid 12/29/2021
8350015-Water Meter Fee $820.29 $820.29 Paid 12/29/2021
9110068-Storm Fee $419.52 $419.52 Paid 12/29/2021
9110071-Site Grading Fee $532.56 $532.56 Paid 12/29/2021
9110081-Paved Surface Inspection Fee $6,619.09 $6,619.09 Paid 12/29/2021
$6,619.10
91100C9-Water Insp Fee $105.00 $105.00 Paid 12/29/2021
91100C8-Sanitary Sewer Insp Fees $69.08 $69.08 Paid 12/29/2021
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 07/29/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Residential Partial 02/09/2022
Miscellaneous Correction
Informational
02/09/2022

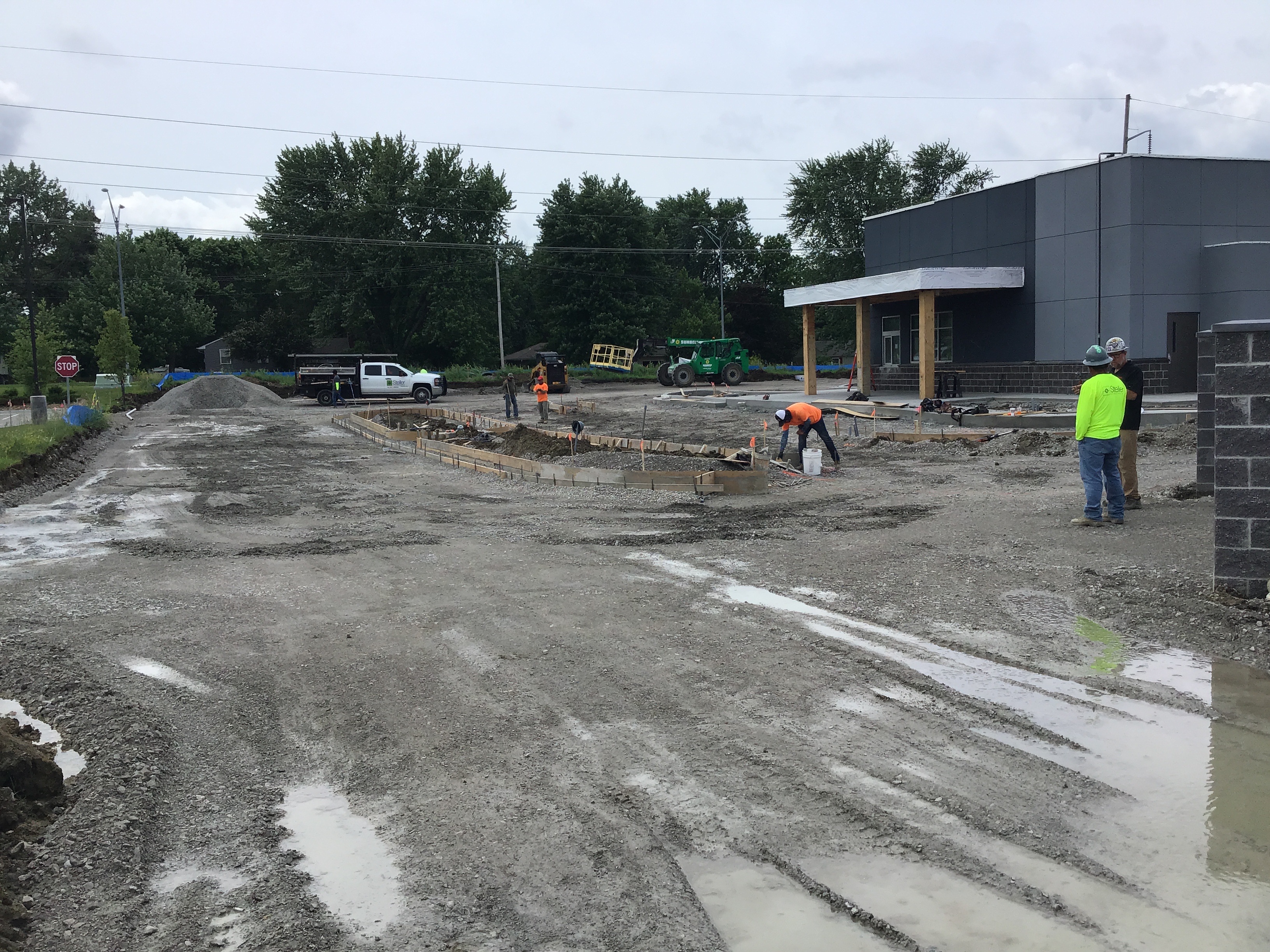

02/08/22 Tuesday Contractor installed erosion control around two week ago. Erosion control measures are still effective. 02/16/22 Wednesday Contractor installed erosion control is still maintain. 03/23/22 Wednesday Erosion control measures and devices are operable. 7-14-22 RH. Erosion control in place and working correctly.
Grading/Excavation/Fill Inspection Partial 02/09/2022
Misc
Informational
02/09/2022
02/09/22 Wednesday Contractor continues to grade site and prep to install building pad. 02/16/22 Wednesday Contractor continues to grade site.
Footing Inspection - Commercial Partial 2/22/2022 (9:00) 2/22/2022 02/22/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/22/2022
BUILDING FOOTING PER PLAN OK TO POUR, COVER POUR TO PROTECT AGAIST WEATHER. UFER LOCATED NORTH END OF BLDG
Sewer Service Inspection Partial 2/22/2022 02/22/2022
Misc
Informational
02/22/2022
02/22/22 Tuesday Contractor installed approximately 70’ of 6” SDR-26 sanitary pipe. 02/25/22 Wednesday Contractor installed 3/ 6” wyes and 3/22 deg bends approximately 20’ of 6” SDR-26 sanitary pipe. 02/28/22 Monday (Bair Excavating) Contractor excavated work that was done on 02/25/22 was supposed to 4” not 6” and installed by the Plumber’s. 03/02/22 Wednesday Contractor installed Hardback Fernco to grease trap connecting 6” sanitary to 4” grease trap line. Codes is schedule to inspect grease trap today.
Footing Inspection - Commercial Partial 2/22/2022 (2:00) 2/22/2022 02/22/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/22/2022
BUILDING FOOTING PER PLAN OK TO POUR, COVER POUR TO PROTECT AGAIST WEATHER. UFER LOCATED NORTH END OF BLDG FOOTING TRASH ENCLOSURE
Site Visit Partial 02/23/2022
Misc
Informational
02/23/2022
02/23/22 Wednesday Contractor was constructing building pad. Footing and base was poured for dumpster enclosure. No work was done on underground utilities work is scheduled to restart by Friday depending on weather. 02/24/22 Thursday No work. 03/03/22 Thursday Contractor is working onsite, but working building pad. 03/16/22 Wednesday Contractor is working onsite, but not on related work. 03/31/22 Thursday No work. 04/01/22 Friday Work the building, but no related work. 04/05/22 Tuesday No related work on site. 04/06/22 Wednesday No related work onsite. 04/25/22 Monday Construction at site of building see picture. 04/26/22 Tuesday Construction continues at the site, no related work.
Water Service Inspection Partial 02/26/2022
Misc
Informational
02/26/2022

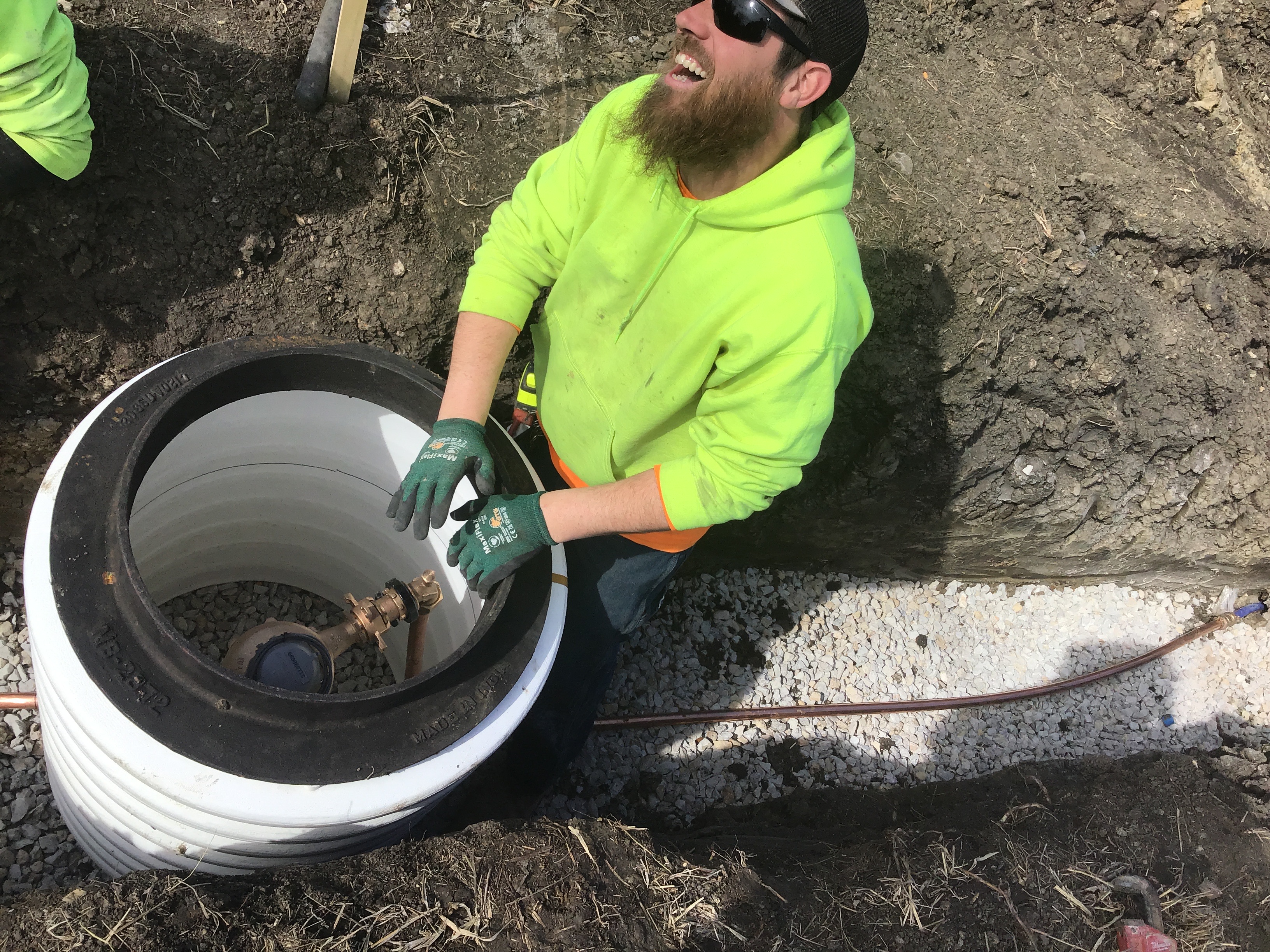

02/26/22 Saturday (Bair’s Excavating) Contractor exposed city water main to be Tap in for the 1” service line for water meter. Orange safety fence was installed around excavated area. Contractor will run 1” blue poly water main for domestic service line. 1” tap is scheduled for next week. 02/28/22 Monday (Bair Excavating) City of Lee’s Summit made the tap for meter and drop off meter assembly. Contractor worked to install meter pit and finish domestic 1” water line.
Underslab Plumbing Inspection - Commercial Passed 3/1/2022 3/1/2022 03/01/2022
Underground Plumbing Inspection - Commercial Passed 3/2/2022 03/02/2022
Misc
Informational
03/02/2022
GREASE INTERCEPTOR
Underslab Electrical Inspection - Commercial Passed 3/3/2022 3/3/2022 03/03/2022
Underslab Plumbing Inspection - Commercial Passed 3/3/2022 3/3/2022 03/03/2022
Rough Framing Inspection - Commercial Failed 3/16/2022 03/16/2022
Miscellaneous Correction
Corrective Action Required
03/16/2022
EXTERIOR WALL SHEATHING NAILING PATTERN NAIL PER PLAN WALL SHEATHING AND NAILING SCHEDULE Nail corner of electrical room near back door per plan Nail below front window Nail west side right of window Nail West side near water line
Rough Framing Inspection - Commercial Partial 3/17/2022 3/17/2022 03/17/2022
Miscellaneous Correction
Resolved
03/17/2022
EXTERIOR WALL SHEATHING NAILING PATTERN APPROVED
In-wall Inspection Failed 4/4/2022 4/4/2022 04/04/2022
Miscellaneous Correction
Corrective Action Required
04/04/2022
Complete vent to roof near front window Fire caulk upward penetrations Seal gaps in fire blocking Provide vertical fire blocking every 10' at furr out areas Complete roof drains at outside dining area
In-wall Inspection Passed 4/5/2022 4/5/2022 04/05/2022
Miscellaneous Correction
Resolved
04/05/2022
Storm Sewer Construction Inspection Partial 04/12/2022
Misc
Informational
04/12/2022

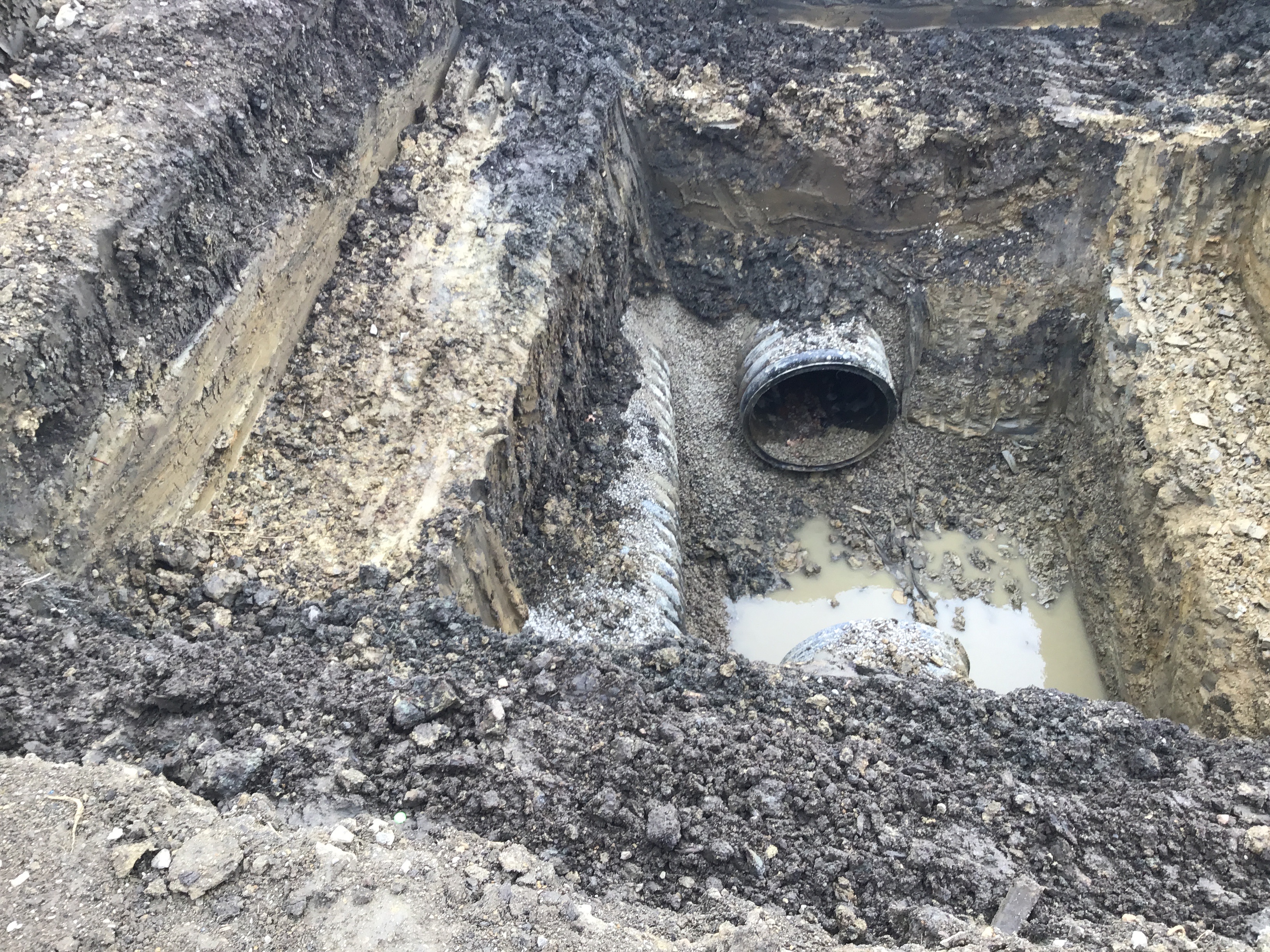

04/12/22 Tuesday (Bair Construction) Contractor located existing two 36” storm pipes to install storm boxes. Tomorrow weather permitting storm installation began. Excavation for storm pipe will be fenced off by contractor. 04/13/22 Wednesday (Bair Construction) Contractor will be getting storm boxes to install on existing and new storm lines. Storm box MH 300 was installed and the 36” corrugated HPDE coupling that connects to the existing. 04/14/22 Thursday (Bair Construction) Contractor excavated and cut out section to install Storm box MH 100 base. 36” corrugated HPDE coupling will be installed that connects to existing storm line. 04/15/22 Friday (Bair Construction) Contractor is working to set Storm box MH 101 base. They will be pouring collars, inverts, and pouring the floor with rebar around 1:00 PM. 04/18/22 Monday (Bair Construction) Contractor installed mid & upper section storm box, storm lids. Backfilling and compaction is being done around storm boxes. 04/19/22 Tues (Bair Construction) Contractor installed 40’ of 12” HP storm pipe from storm box 101 to 100 04/18/22 Monday. Contractor installed boxes 201 & the base of 200 and ran 100’ of 15” Storm pipe. Collars and inverts for Storm lines 200 we be completed today. The base of storm box 200 was installed at the existing 36” storm pipe and newly installed 15” storm pipe located on the Southwest side. Contractor sent pictures of the rebar that was installed before the floor for storm boxes 100 & 101. 04/20/22 Wednesday (Bair Construction) A bust in elevation at storm box 200 force the contractor to Install rebar & frame wall expansion of 21” to meet the grade of curb. The walls to the North and South were framed poured today. Tomorrow the East and West walls will be constructed. See picture for today of wall expansion. 04/21/22 Thursday (Bair Construction) Curb Inlet side walls where constructed and poured @ CI 200. 04/22/22 Friday (Bair Construction) Storm box lids where installed on line 200.
Sewer Service Inspection Passed 3/2/2022 3/2/2022 04/14/2022
Misc
Informational
02/22/2022
02/22/22 Tuesday Contractor installed approximately 70’ of 6” SDR-26 sanitary pipe.
Site Visit Partial 05/11/2022
Misc
Informational
02/23/2022
02/23/22 Wednesday Contractor was constructing building pad. Footing and base was poured for dumpster enclosure. No work was done on underground utilities work is scheduled to restart by Friday depending on weather.
Misc
Informational
05/11/2022
5-11-22 AN no work being done
Pavement-Curb Construction Partial 05/16/2022
Misc
Informational
05/16/2022

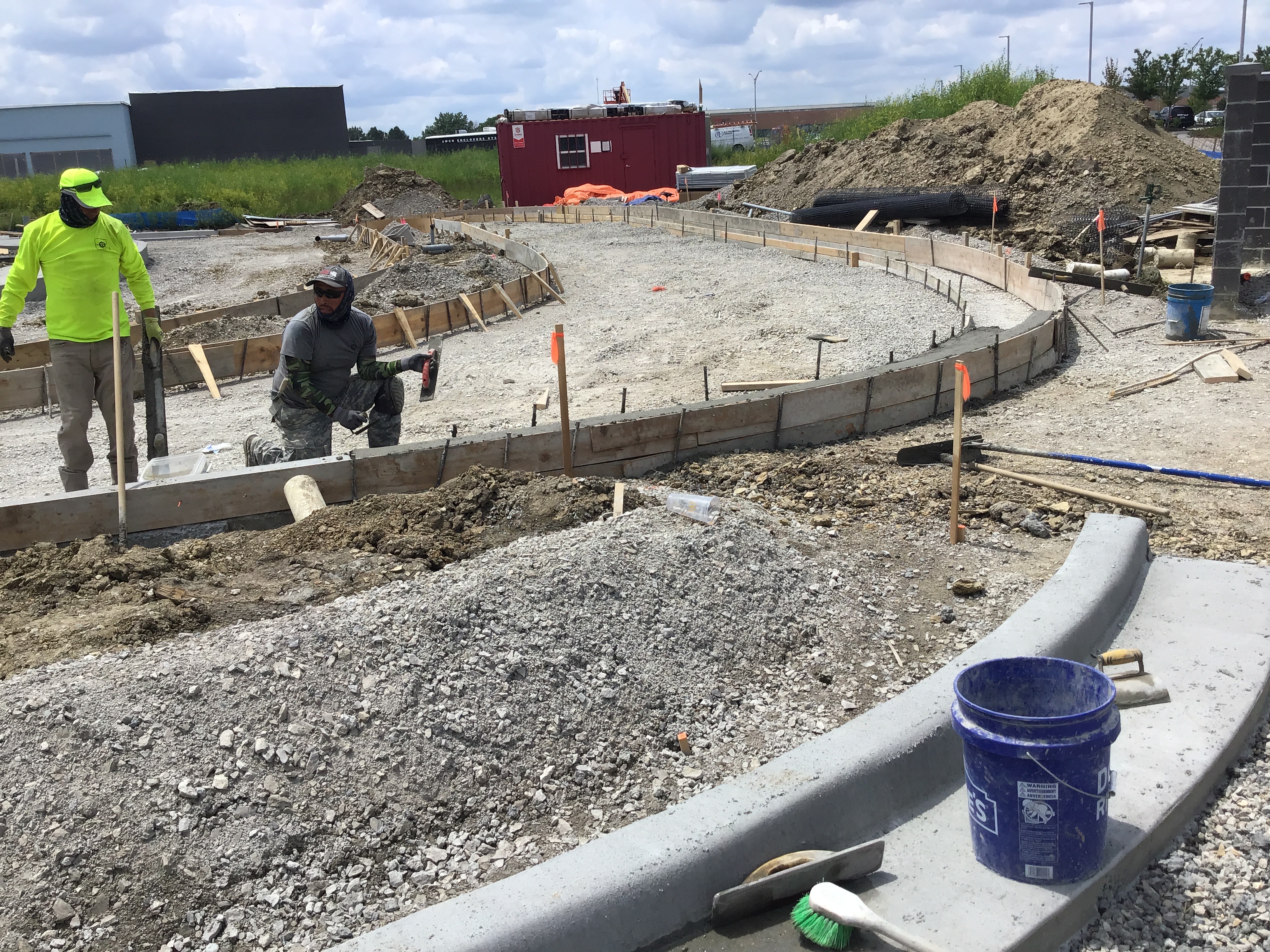

5-16-22 AN contractor has survey stacks for the curbs in place and plan on trying to do curbs later this week
Pavement-Curb Construction Partial 05/17/2022
Misc
Informational
05/16/2022
5-16-22 AN contractor has survey stacks for the curbs in place and plan on trying to do curbs later this week 5-17-22 AN crew is busting up the high back curb for putting in the drive approach
Pavement-Curb Construction Partial 05/18/2022
Misc
Informational
05/17/2022
5-16-22 AN contractor has survey stacks for the curbs in place and plan on trying to do curbs later this week 5-17-22 AN crew is busting up the high back curb for putting in the drive approach 5-18-22 AN crew still prepping for curbs
Above Ceiling Inspection Passed 5/23/2022 5/23/2022 05/23/2022
Rough Framing Inspection - Commercial Failed 5/23/2022 05/23/2022
Misc
Resolved
05/23/2022
EXTERIOR WALL SHEATHING NAILING PATTERN APPROVED
Miscellaneous Correction
Corrective Action Required
05/23/2022
WALK UP CANOPY COMPLETE LEDGER LOCK SCREWS SOUTH END DOUBLE JOIST HANGERS ARE UPSIDE DOWN NORTH & SOUTH ENDS
Pavement-Aggregate Base Partial 05/23/2022
Misc
Corrective Action Required
05/23/2022
5/23/22 (Bair Const. Shane Bair) A sub-grade inspection was done and the soil has retain moisture throughout. Third part inspector Geotechnology Inc. will recommend correction to stabilize sub-grade. Contractor will contact me when they ready to perform stabilization.
Rough Framing Inspection - Commercial Partial 5/24/2022 5/24/2022 05/24/2022
Miscellaneous Correction
Resolved
05/24/2022
WALK UP CANOPY APPROVED
Gas Service Inspection - Commercial Passed 6/3/2022 6/3/2022 06/03/2022
Pavement-Stabilized Subgrade Passed 06/03/2022
Misc
Informational
06/03/2022
6-3-22 AN Bair did fly ash proof roll (passed) then Geo grid with rock on that.
Underground Plumbing Inspection - Commercial Passed 6/7/2022 6/7/2022 06/07/2022
Curb - Proof Roll Passed 06/08/2022
Misc
Informational
06/08/2022
06/08/22 Wednesday (Adam Nacke Inspector) Curb proof roll was completed and passed last week.
Commercial Curb Inspection Partial 06/08/2022
Misc
Informational
06/08/2022
06/08/22 Wednesday (Adam Nacke Inspector) Apportion of the curbs were installed Adam Nacke observed and inspected last week. John M. Jackson Contractor formed and pour curb for island to the East of Building. Contractor poured approximately 14yd of concrete. 06/09/22 Thursday (Bair Const.) Contractor continues to form frames for curb construction. Contractor poured outside curbs to driveway/parking lot just South of building approximately 4yd were poured. 06/10/22 Friday Contractor poured approximately 13yd of concrete pouring the rest of the outer curbs in the parking lot to the East of building and the drive thru curbs. 06/14/22 Tuesday Drive thru island were poured.
Piers/Caissons Inspection - Commercial Passed 6/14/2022 (11:00) 6/14/2022 06/14/2022
Miscellaneous Correction
Corrective Action Required
06/14/2022
(6) light pole bases with ground rods
Pavement-Proof Roll Passed 06/21/2022
Misc
Informational
06/03/2022
6-3-22 AN Bair did fly ash proof roll (passed ) then Geo grid with rock on that. Ask Steve if they need a second proof roll.
Misc
Informational
06/21/2022
06/21/22 Tuesday (Bair Const.) Proof roll appeared to pass test. No serious deflection of ground.
Pavement-Proof Roll Passed 6/21/2022 06/23/2022
Misc
Informational
06/03/2022
6-3-22 AN Bair did fly ash proof roll (passed ) then Geo grid with rock on that. Ask Steve if they need a second proof roll.
Misc
Informational
06/23/2022
06/23/22 Thursday (Bair Construction) Proof passed on the 06/21/22 Tuesday.
Pavement-Surface Passed 06/28/2022
Misc
Informational
06/28/2022
06/28/22 Tuesday (Bair Construction) Contractor laid down base asphalt over the weekend, density test were taken and the contractor will send me the results. I was not aware the contractor would be laying asphalt.
Footing Inspection - Commercial Failed 6/29/2022 (8:00) 6/29/2022 06/29/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
02/22/2022

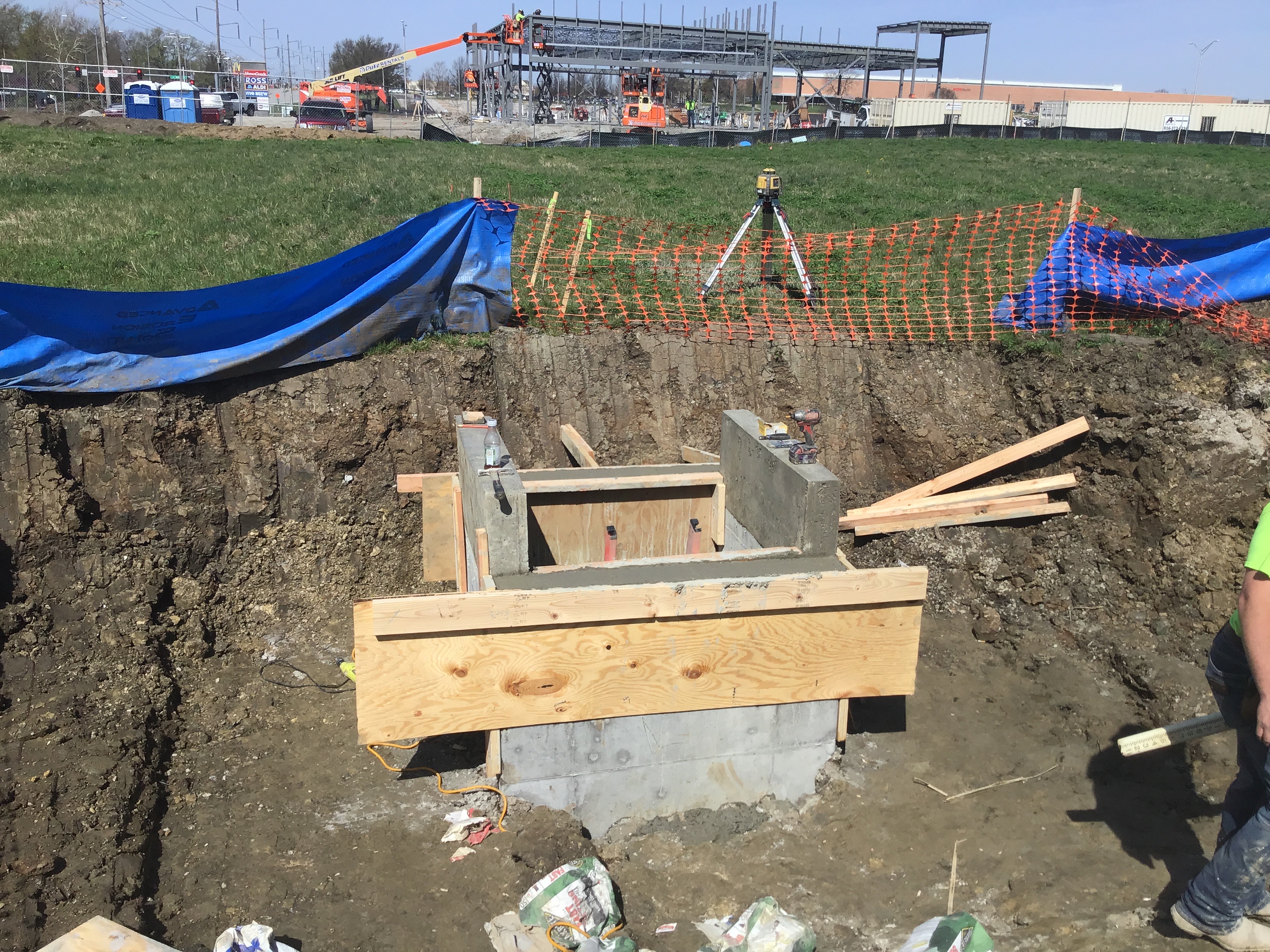

BUILDING FOOTING PER PLAN OK TO POUR, COVER POUR TO PROTECT AGAIST WEATHER. UFER LOCATED NORTH END OF BLDG FOOTING TRASH ENCLOSURE
Misc
Corrective Action Required
06/29/2022
Provide pier per approved structural drawings at monument sign
Footing Inspection - Commercial Passed 6/29/2022 6/29/2022 06/29/2022
THE FOLLOWING AREAS ARE APPROVED
Informational
06/29/2022
BUILDING FOOTING PER PLAN OK TO POUR, COVER POUR TO PROTECT AGAIST WEATHER. UFER LOCATED NORTH END OF BLDG FOOTING TRASH ENCLOSURE FOOTING FOR MONUMENT SIGN
Misc
Resolved
06/29/2022
Provide pier per approved structural drawings at monument sign
Commercial Curb Inspection Partial 07/05/2022
Misc
Informational
06/08/2022
06/08/22 Wednesday (Adam Nacke Inspector) Apportion of the curbs were installed Adam Nacke observed and inspected.
Misc
Informational
07/05/2022

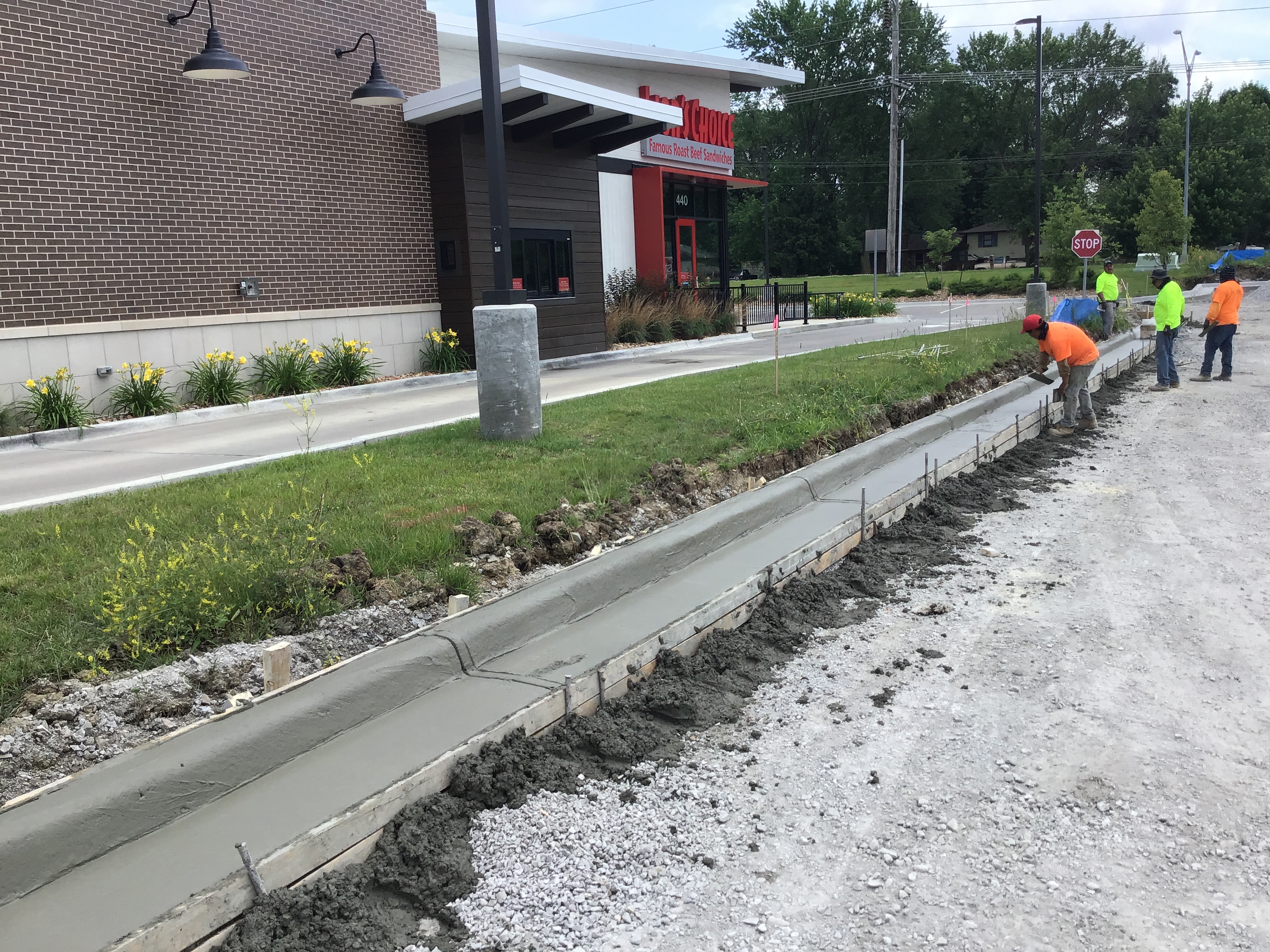

7-5-22 AN freedom is working on the curbs for the approach
Commercial Curb Inspection Partial 07/05/2022
Misc
Informational
07/05/2022
06/08/22 Wednesday (Adam Nacke Inspector) Apportion of the curbs were installed Adam Nacke observed and inspected.
Misc
Informational
07/05/2022
7-5-22 AN freedom is working on the curbs for the approach 1:30pm curb approach is complete but it appears that they did not put cure on the curbs
Driveway Inspection Partial 07/06/2022
Misc
Informational
07/06/2022
07/06/22 Wednesday Contractor is removing soil and gravel from approach to obtain stabilization. 07/08/22 Friday Contractor flowable filled commercial parking approach area yesterday to stabilize subgrade. Contractor found that Lion Choice irrigation system was leaking toward the parking entrance area. 07/09/22 Saturday ( Wil-Pav ) Type 2 asphalt was laid @ driveway entrance.
Electrical Service Inspection Passed 7/8/2022 07/08/2022
Sign Confirmation Inspection Partial 8/2/2022 07/12/2022
Misc
Informational
07/12/2022
07/12/22 Tuesday Contractor began stripping parking lot 3:53PM.
Sign Confirmation Inspection Passed 8/2/2022 07/20/2022
Misc
Informational
07/12/2022
07/12/22 Tuesday Contractor began stripping parking lot 3:53PM.
Occupancy Inspection - Planning Temporary C of O 7/26/2022 7/26/2022 07/26/2022
Corrective Action Required
07/26/2022
LANDSCAPING. Complete installation of sod and landscaping per the approved plan.
Occupancy Inspection - Fire Failed 7/26/2022 7/26/2022 07/26/2022
Occupancy Inspection - Codes Commercial Failed 7/26/2022 7/26/2022 07/26/2022
Misc
Corrective Action Required
07/26/2022
-Complete corrections for all other departments -Label RTUs and disconnect -Backflow devices at all hard piped equipment -All drain lines to be 1” above flood level rim -Remove trash from rooftop -Vertical grab bar to be 39-41 aff -Mirror to be 40” to reflective surface -Provide restroom signage -Connect light pole ground to equipment ground
Occupancy Inspection - Water Utilities Temporary C of O 7/26/2022 07/26/2022
Miscellaneous Correction
Corrective Action Required
07/26/2022
Provide backflow certification results for the domestic water service and irrigation devices.
Occupancy Inspection - Engineering Temporary C of O 7/26/2022 07/27/2022
Misc
Informational
07/27/2022
TCO is Given Punch list for Final Occupancy 1.Vegetationof 70% 2. Clean up all trash and debris 3. Make sure curb inlets and clean and no debris inside.
Occupancy Inspection - Codes Commercial Ready for Temp CO 7/29/2022 7/29/2022 07/29/2022
Misc
Corrective Action Required
07/26/2022
Pending Planning , FEI approval Codes & Fire complete. 2 Backflow reports will be uploaded to portal.
Occupancy Inspection - Codes Commercial Temporary C of O 7/29/2022 07/29/2022
Misc
Corrective Action Required
07/29/2022
Pending Planning , FEI approval Codes & Fire complete. 2 Backflow reports will be uploaded to portal.
Occupancy Inspection - Fire Passed 8/4/2022 7/29/2022 08/01/2022
Corrective Action Required
08/01/2022
All life safety was appropriate. Okay to occupy with approval form codes.
Corrective Action Required
08/01/2022
Occupancy Inspection - Planning Passed 8/4/2022 8/4/2022 08/04/2022
Occupancy Inspection - Engineering Passed 7/29/2022 08/04/2022
Misc
Informational
07/27/2022
TCO is Given Punch list for Final Occupancy 1.Vegetationof 70% 2. Clean up all trash and debris 3. Make sure curb inlets and clean and no debris inside.
Misc
Informational
08/04/2022
Final Occupancy can be give on our end.
Driveway Inspection Passed 08/04/2022
Misc
Informational
07/06/2022
07/06/22 Wednesday Contractor is removing soil and gravel from approach to obtain stabilization.
Commercial Curb Inspection Passed 08/04/2022
Misc
Informational
07/05/2022
06/08/22 Wednesday (Adam Nacke Inspector) Apportion of the curbs were installed Adam Nacke observed and inspected.
Misc
Informational
07/05/2022
7-5-22 AN freedom is working on the curbs for the approach 1:30pm curb approach is complete but it appears that they did not put cure on the curbs
Storm Sewer Construction Inspection Passed 08/04/2022
Misc
Informational
04/12/2022

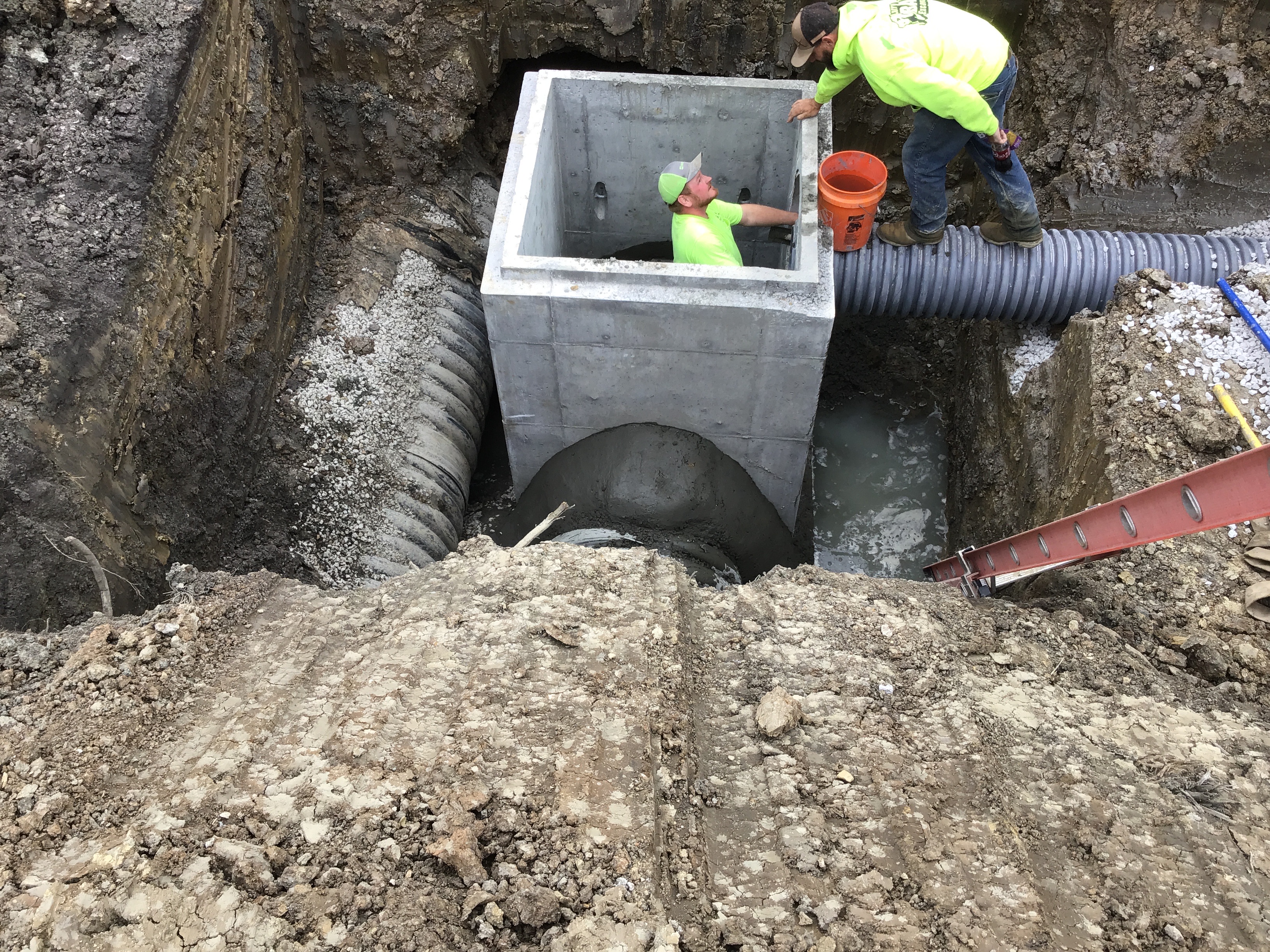

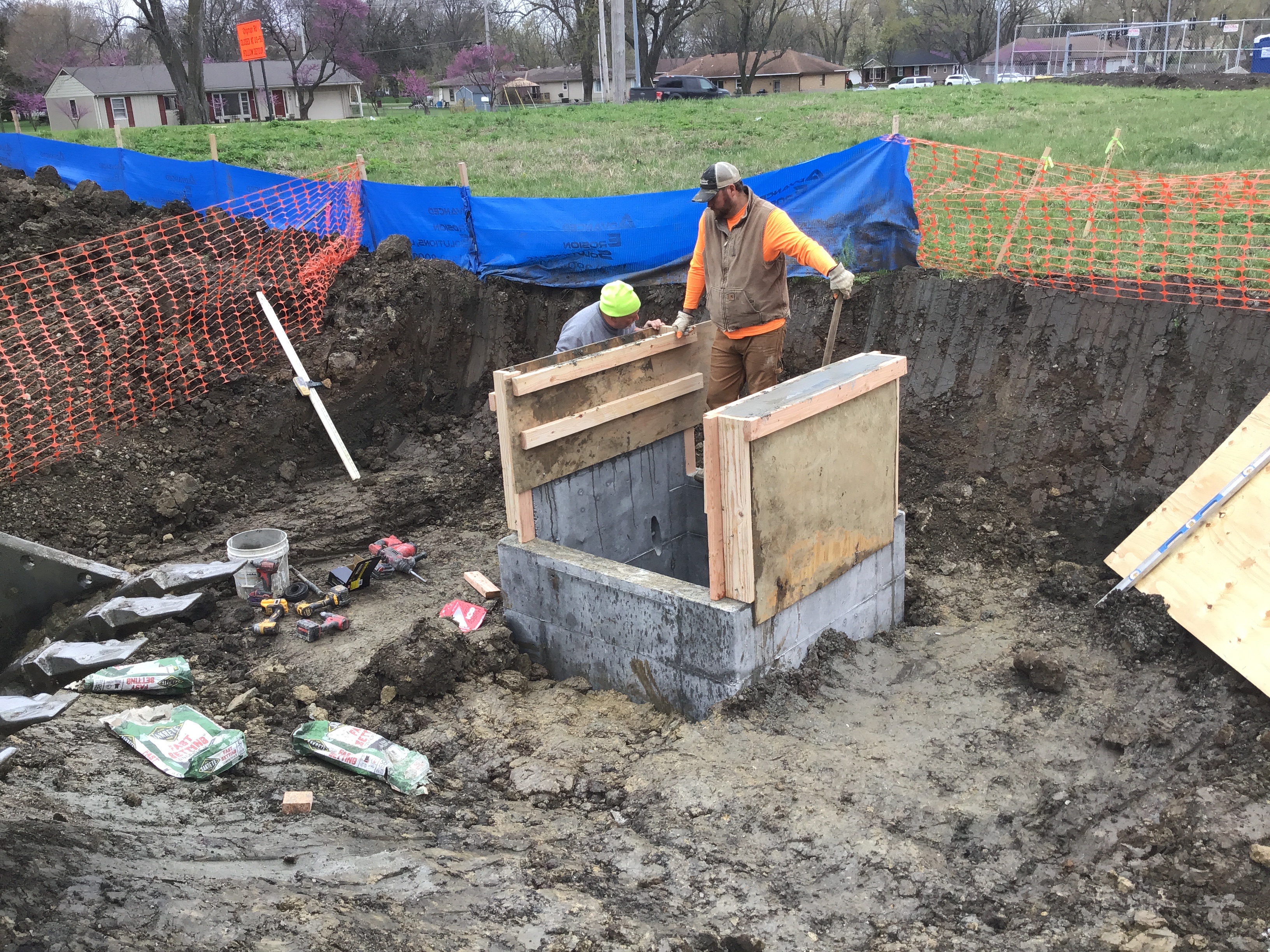

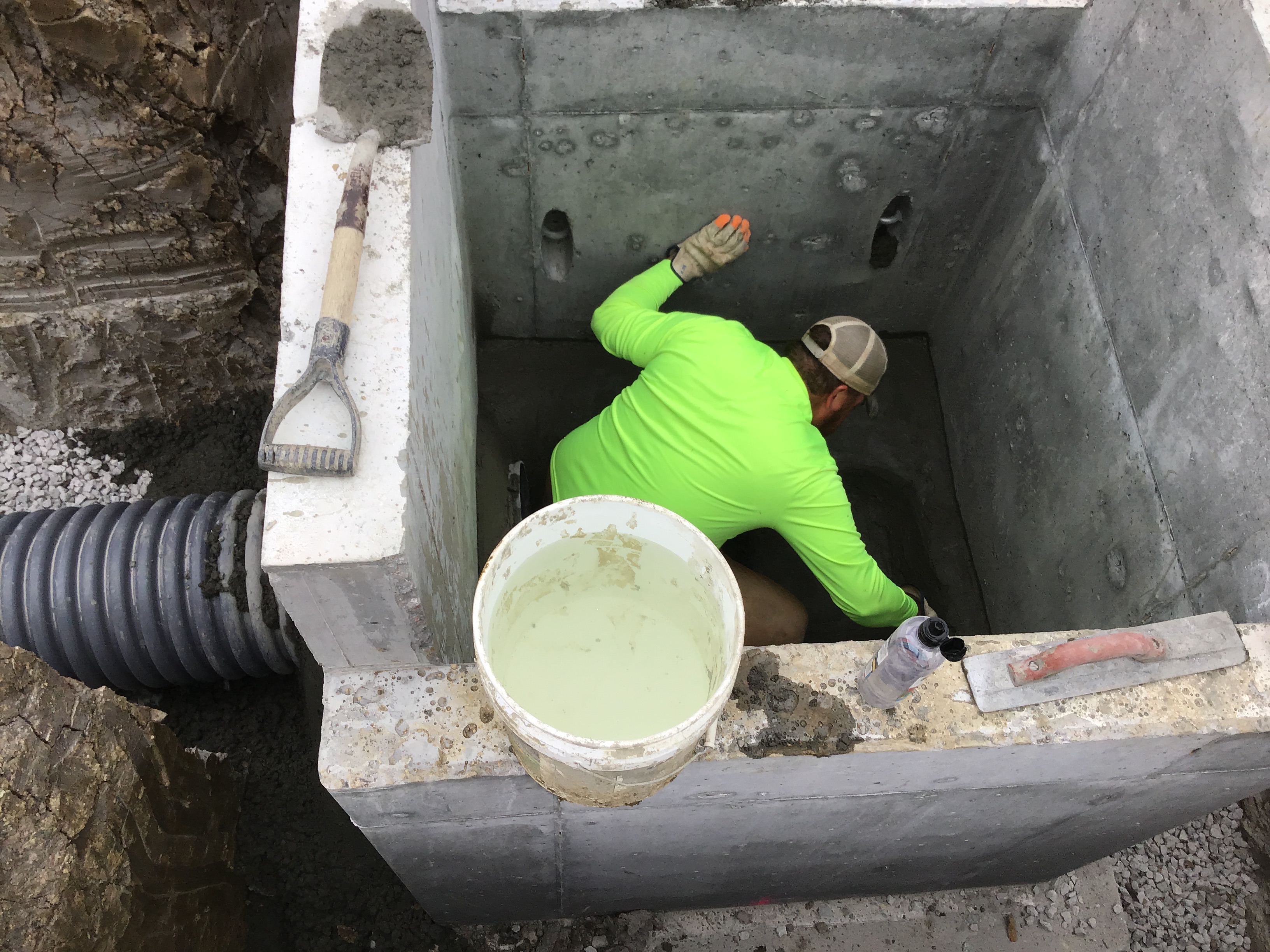

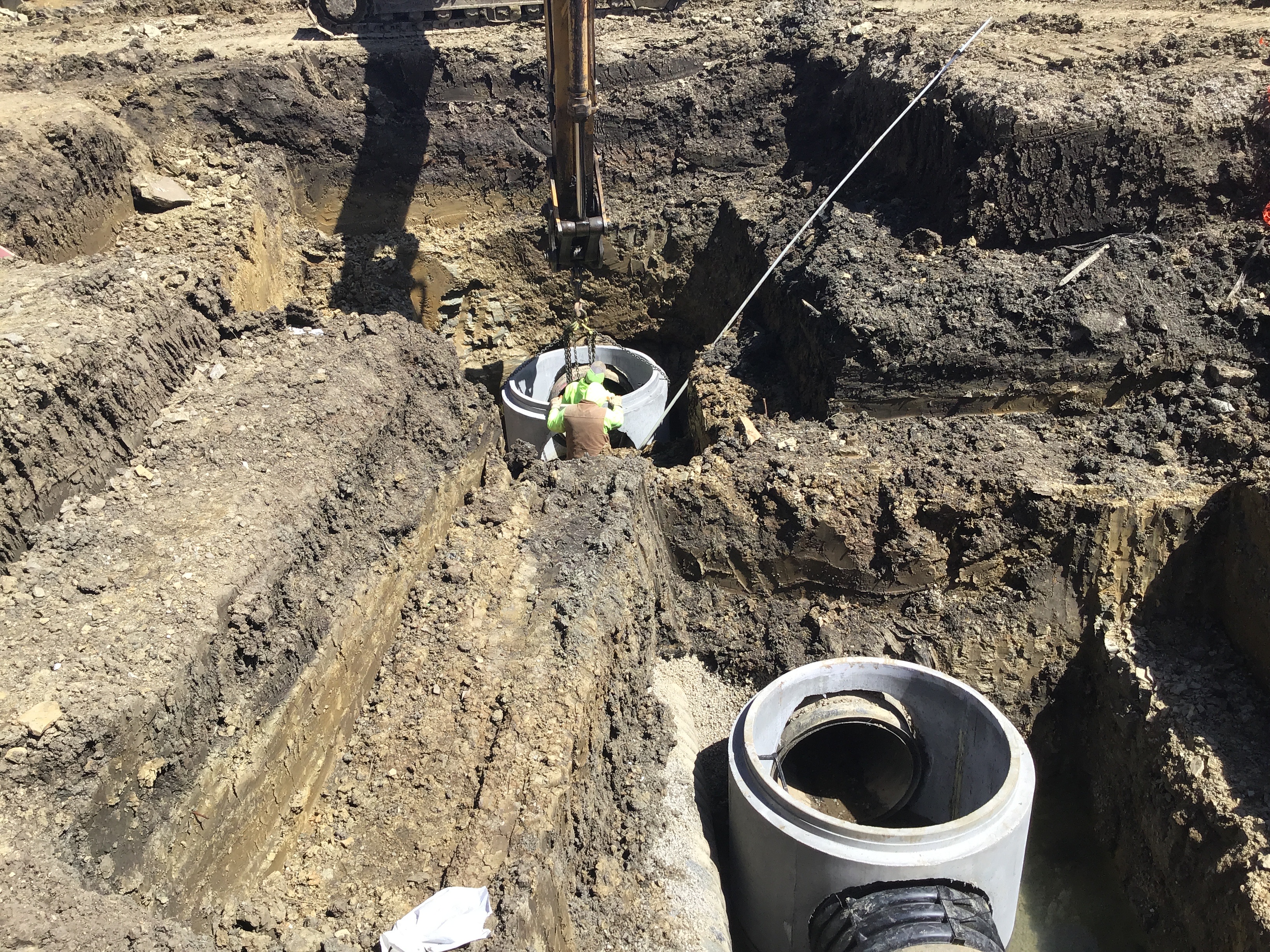

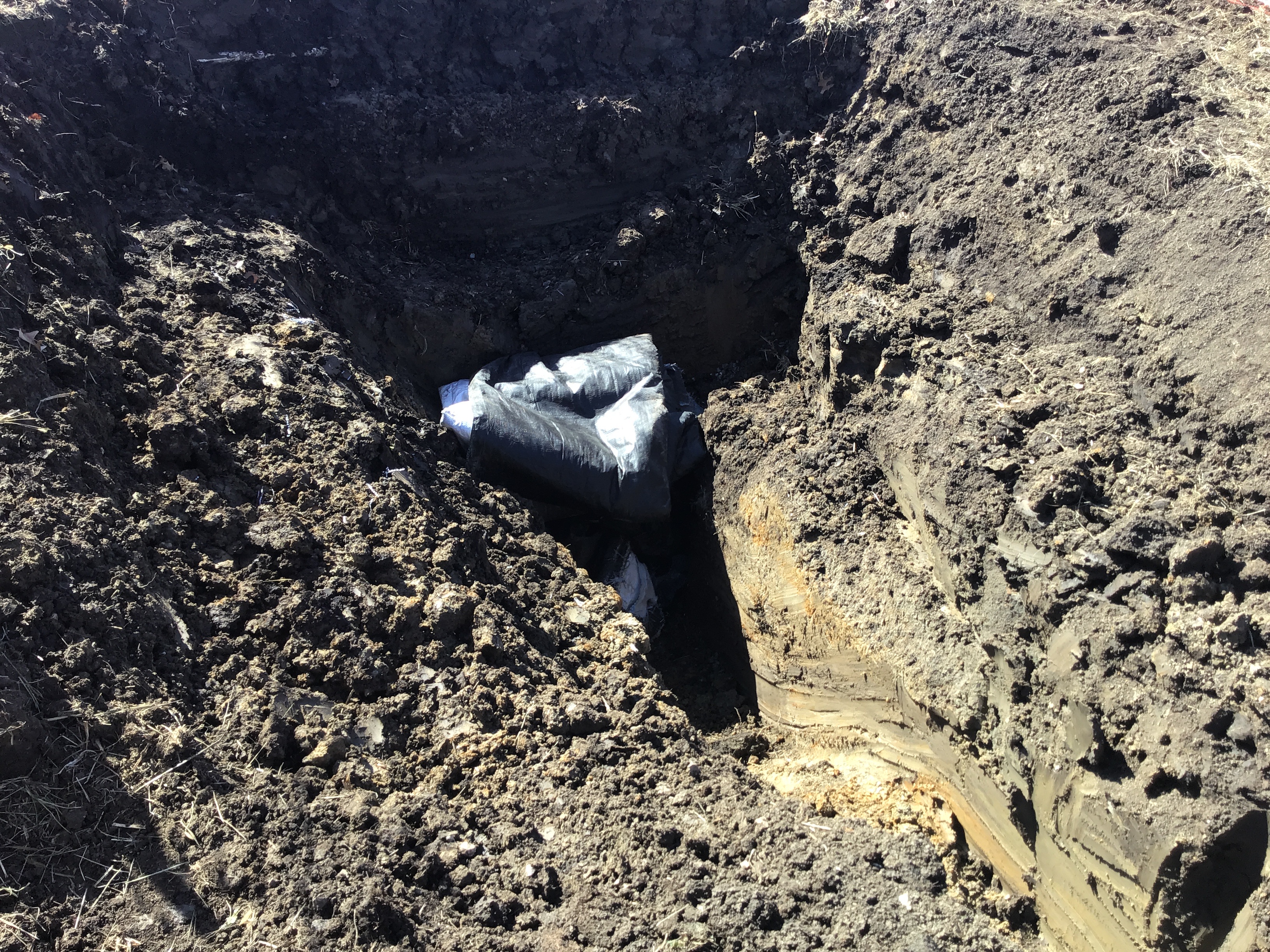

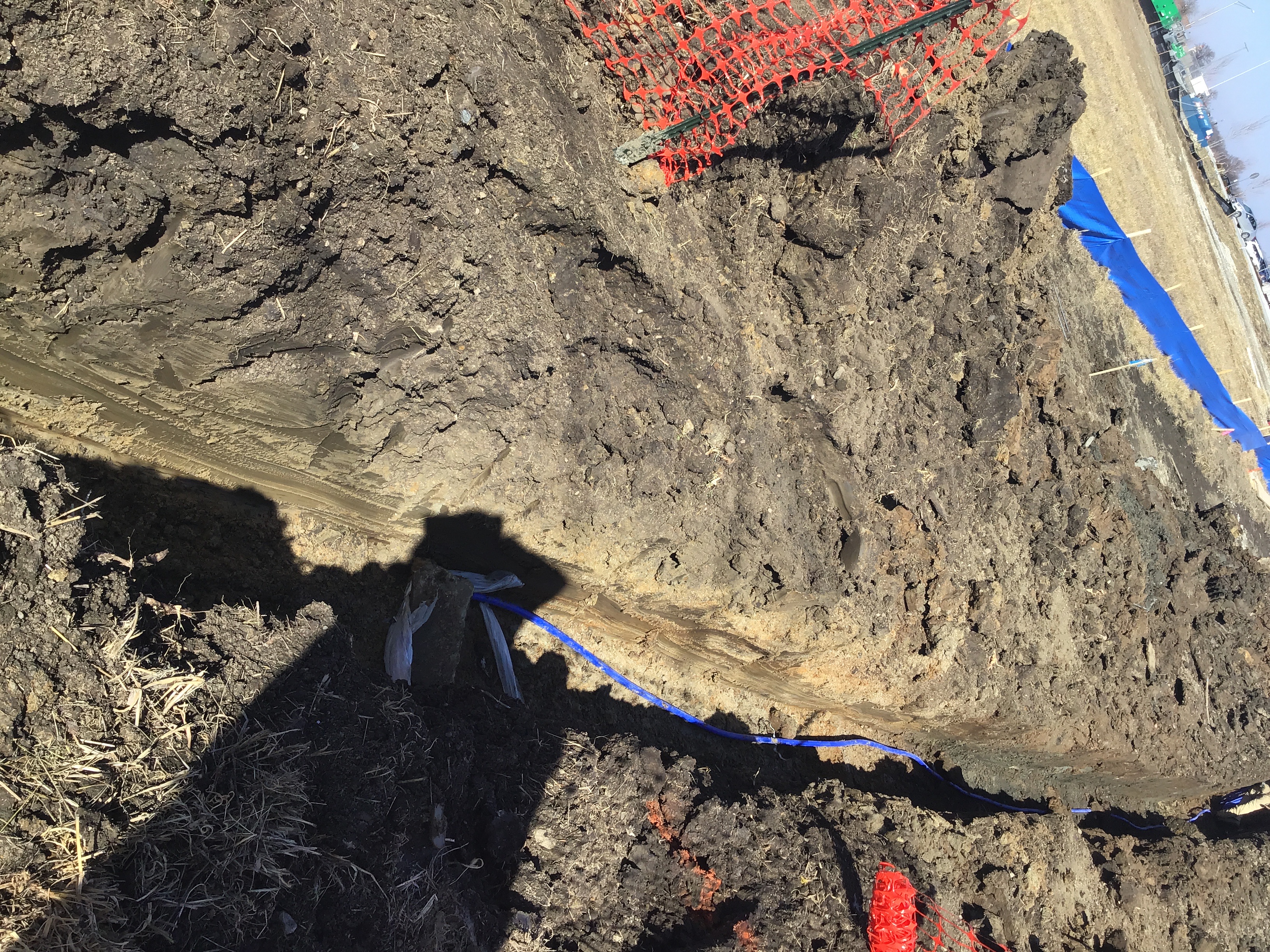

04/12/22 Tuesday (Bair Construction ) Contractor located existing two 36” storm pipes to install storm boxes. Tomorrow weather permitting storm installation began. Excavation for storm pipe will be fenced off by contractor.
Water Service Inspection Passed 08/04/2022
Misc
Informational
02/26/2022

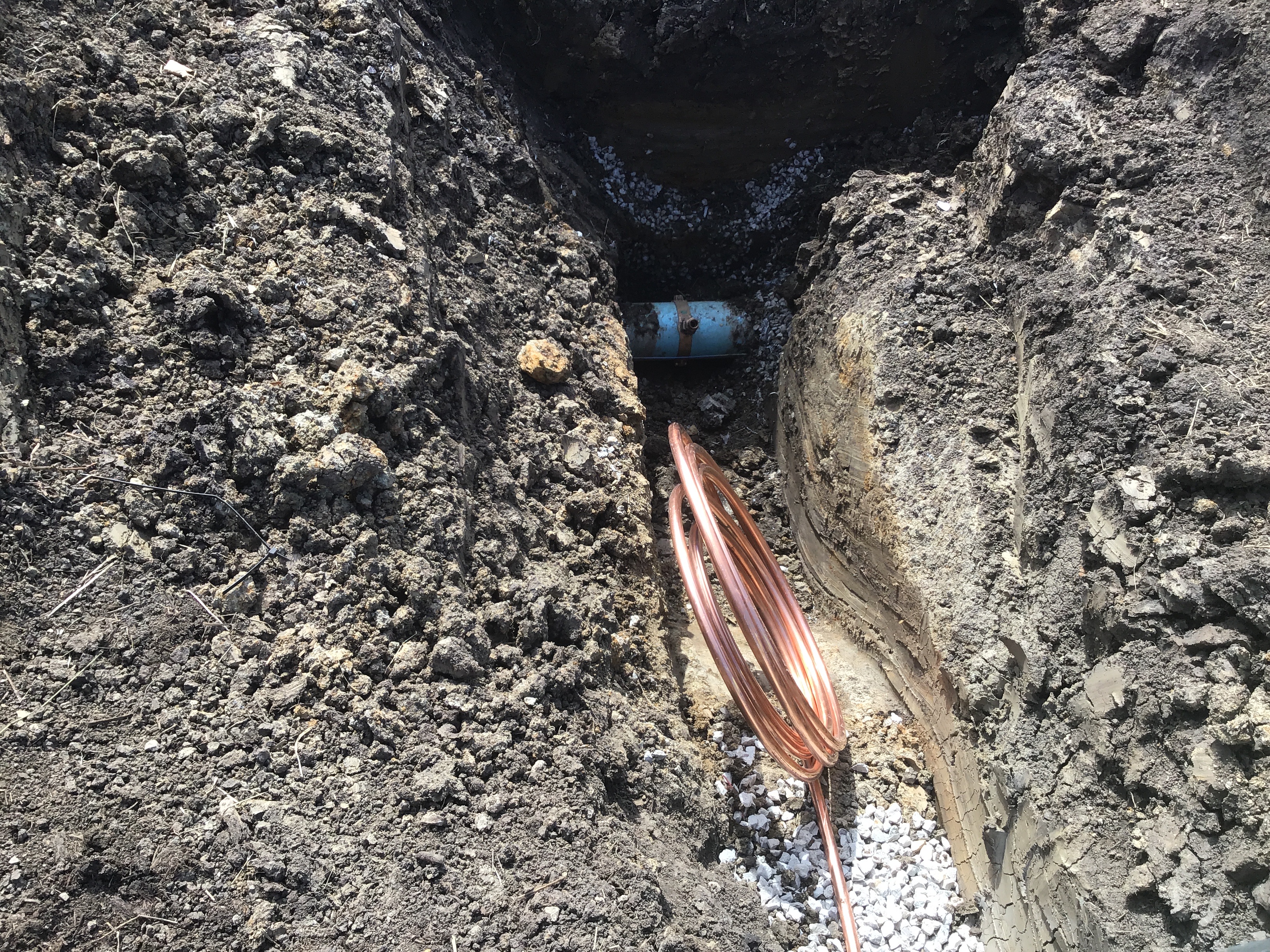

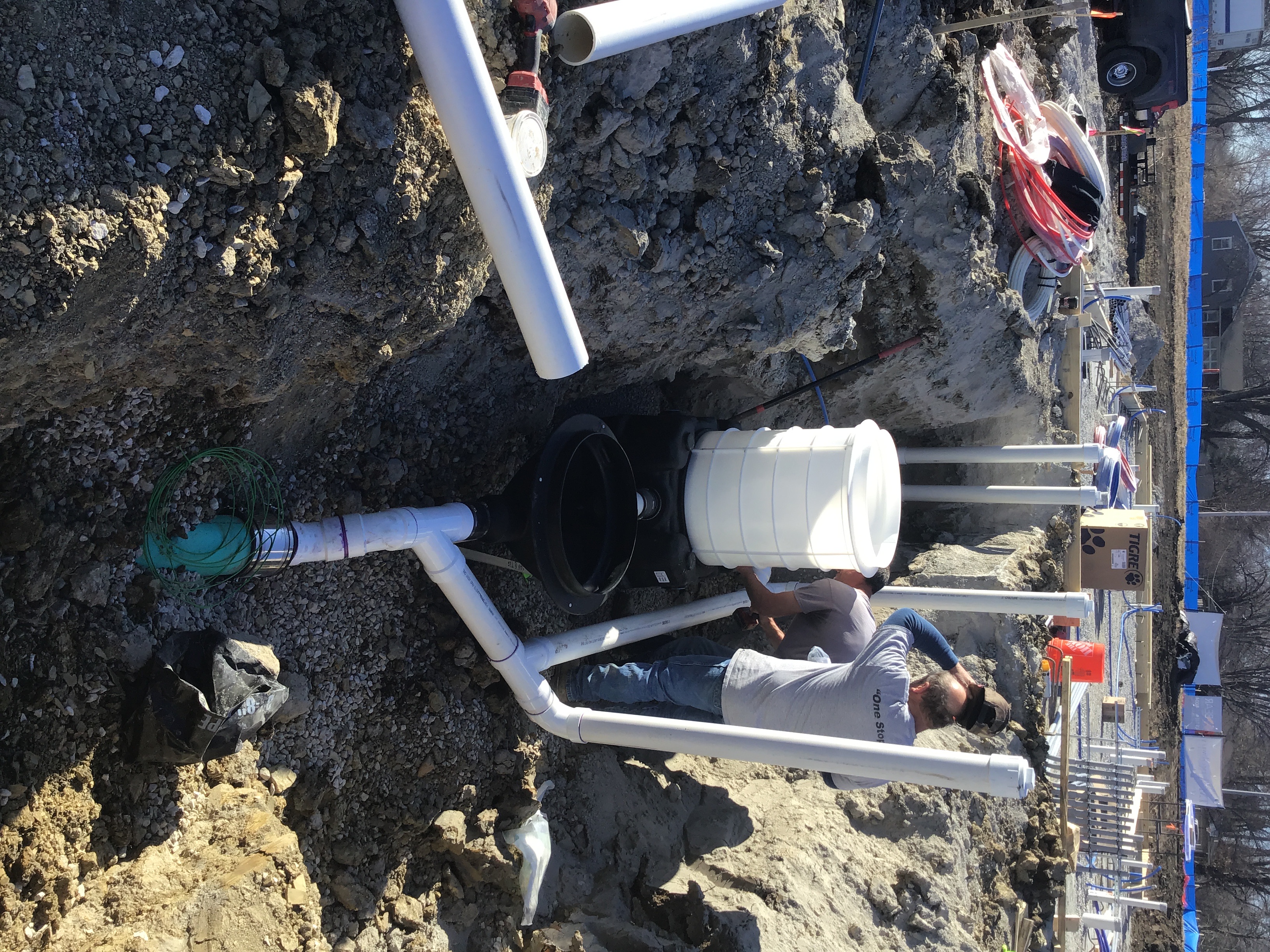

02/26/22 Saturday (Bair’s Construction) Contractor exposed city water main to be Tap in for the 1” service line for water meter. Orange safety fence was installed around excavated area. Contractor will run 1” blue poly water main for domestic service line. 1” tap is scheduled for next week.
ESC - (Vegetation/Ground Cover) Partial 08/04/2022
Occupancy Inspection - Codes Commercial Full C of O 8/4/2022 8/5/2022 08/05/2022
Misc
Resolved
08/05/2022
Pending Planning , FEI approval Codes & Fire complete. 2 Backflow reports will be uploaded to portal.
Occupancy Inspection - Water Utilities Passed 8/4/2022 08/08/2022
Miscellaneous Correction
Corrective Action Required
07/26/2022
Provide backflow certification results for the domestic water service and irrigation devices.
Documents & Images
Date Uploaded File Type Document Name
10/13/2021 Engineer Report/Study Dutch Bros - MO0102 - 500 NW Chipman Rd - Structural Calcs - 20211013
10/13/2021 Plans Dutch Bros - MO0102 - 500 NW Chipman Rd - Permit Set - 20211013
10/13/2021 Application Form _License Tax - 500 NW Chipman Rd. - 20211013 - Signed
10/13/2021 Letter License Tax Bill
10/13/2021 Letter Fire Building Plan Review
10/18/2021 Email New Food Establishment Plan Review - Approved FTG_0001781
10/19/2021 Letter DS P/R Corrections Document
10/19/2021 Application Form _Comm Permit Application - 500 NW Chipman Rd_ - Revised - 20211019
10/28/2021 Plans _DB2550-A1_MO0102 Lee's Summit-Permit Rev_ 1_10-28-2021
10/28/2021 Letter Fire Building Plan Review
11/01/2021 Letter DS P/R Corrections Document
11/03/2021 Letter Response to City comments MO0102 Dutch Bros Lee's Summit MO
11/03/2021 Engineer Report/Study Geotechnical Report Lee's Summit
11/03/2021 Plans MO0102_Rev 2 Submittal 11-3-2021
11/03/2021 Letter Fire Building Plan Review
11/05/2021 Plans MO0102 DB_Lee's Summit MO_PS 11-5-2021
11/05/2021 Approved Plans approved - MO0102 DB_Lee's Summit MO_PS 11-5-2021
12/06/2021 Approved Plans Approved PL2021394 Dutch Brothers Civil
12/29/2021 Receipt Receipt for transaction: 2021-009525
12/29/2021 Letter DS Building Permit
01/12/2022 Approved Plans approved - sign and clearance bar
02/09/2022 Letter INSPECTION SUMMARY
02/09/2022 Letter INSPECTION SUMMARY
02/16/2022 Letter INSPECTION SUMMARY
02/16/2022 Letter INSPECTION SUMMARY
02/22/2022 Letter INSPECTION SUMMARY
02/22/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/24/2022 Letter INSPECTION SUMMARY
02/25/2022 image
02/25/2022 image0
02/25/2022 Letter INSPECTION SUMMARY
02/26/2022 Letter INSPECTION SUMMARY
02/26/2022 image1
02/26/2022 image2
02/28/2022 image3
02/28/2022 image4
02/28/2022 Letter INSPECTION SUMMARY
02/28/2022 image5
03/01/2022 Letter INSPECTION SUMMARY
03/02/2022 image6
03/02/2022 Letter INSPECTION SUMMARY
03/03/2022 Letter INSPECTION SUMMARY
03/03/2022 Letter INSPECTION SUMMARY
03/16/2022 Letter INSPECTION SUMMARY
03/16/2022 Letter INSPECTION SUMMARY
03/17/2022 Letter INSPECTION SUMMARY
03/21/2022 Plans Dutch Bros - Lee's Summit - Revised Drawings 20220321
03/22/2022 Drawing COR-MO-03-21-M-M-1_0 Mechanical Plan 20220322
03/22/2022 Drawing COR-MO-03-21-M-M-2_0-Details 20220322
03/22/2022 Approved Plans approved-M-1_0 Mechanical Plan 20220322
03/22/2022 Approved Plans approved-M-2_0-Details 20220322
04/04/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/11/2022 Drawing 500 NW Chipman Rd REVISED Layout (1)-KREHER REVIEWED
04/11/2022 Engineer Report/Study VIV 500 NW Chipman Rd REVISED MO 43 Seals-KREHER REVIEWED
04/11/2022 Approved Plans approved trusses
04/12/2022 Letter INSPECTION SUMMARY
04/12/2022 Letter INSPECTION SUMMARY
04/13/2022 image7
04/14/2022 image8
04/14/2022 image9
04/14/2022 Letter INSPECTION SUMMARY
04/19/2022 image10
04/19/2022 image11
04/20/2022 image12
04/21/2022 image13
04/25/2022 image14
05/11/2022 Letter INSPECTION SUMMARY
05/16/2022 Letter INSPECTION SUMMARY
05/17/2022 Letter INSPECTION SUMMARY
05/18/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/24/2022 Letter INSPECTION SUMMARY
06/03/2022 Letter INSPECTION SUMMARY
06/03/2022 Letter INSPECTION SUMMARY
06/03/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 image15
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 image16
06/08/2022 image17
06/10/2022 image18
06/10/2022 image19
06/10/2022 image20
06/14/2022 Letter INSPECTION SUMMARY
06/21/2022 image21
06/21/2022 image22
06/21/2022 Letter INSPECTION SUMMARY
06/21/2022 Letter INSPECTION SUMMARY
06/23/2022 Letter INSPECTION SUMMARY
06/28/2022 Letter INSPECTION SUMMARY
06/29/2022 Letter INSPECTION SUMMARY
06/29/2022 Letter INSPECTION SUMMARY
07/05/2022 Letter INSPECTION SUMMARY
07/05/2022 Letter INSPECTION SUMMARY
07/06/2022 Letter INSPECTION SUMMARY
07/08/2022 Letter INSPECTION SUMMARY
07/08/2022 Letter INSPECTION SUMMARY
07/09/2022 image23
07/09/2022 image24
07/12/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/27/2022 Letter INSPECTION SUMMARY
07/29/2022 3RD Party Insp Report Health License Lee's Summit Dutch
07/29/2022 Fire Department Contact List - Dutch Bros 500 NW Chipman Road
07/29/2022 Receipt Receipt for transaction:2022-006241
07/29/2022 Letter Codes Temporary Certificate of Occupancy
07/29/2022 3RD Party Insp Report Backflow inspection reports
08/01/2022 Letter Fire Loss Reduction Form
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
