Permit Application Status

PRCOM20215559


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20215559
Building Permit - Commercial
Certificate of Occupancy
MSE PROPERTY HOLDINGS GROUP, LLC
NEW COMMERCIAL
REPLACEMENT OF EXISTING BUILDING
10/22/2021
02/02/2023
04/26/2022
04/05/2024
Locations
Contacts
ROSE CONSTRUCTION CO., INC., Address:15311 W 109TH STREET, Phone:(913) 782-0777
WATSON MECHANICAL INC, Address:15311 W 109TH ST, Phone:(913) 782-0777
TEAGUE ELECTRIC CONSTRUCTION INC, Address:12425 W 92ND ST, Phone:(913) 529-4600
Deer Creek Plumbing Inc., Address:19968 W 162ND ST, Phone:(913) 440-9102
mike@buildwithrose.com, Address:mike@buildwithrose.com, Phone:(913) 850-2444
ROSE DESIGN BUILD - CHRIS BELL, Address:15311 WEST 109TH ST, Phone:(913) 782-0777
MSE PROPERTY HOLDINGS GROUP, LLC, Address:14330 S CICERO AVE
Reviews
Review Type Outcome Est. Completion Date Completed
Sprinkler Plan Review Released for Construction 11/05/2021 02/20/2024
Jim Eden
MISC
Corrective Action Required
02/20/2024

Per email from Darryl Glassinger @Alpha Fire Protection LLC, all items noted in the 11/27/2023 Plan Review have been acknowledged and corrected.
Installation acceptance testing
Corrective Action Required
02/20/2024

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule testing.
Alarm Plan Review Released for Construction 02/09/2024 02/06/2024
Jim Eden
Construction documents for fire alarm systems
Corrective Action Required
02/06/2024

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions.
Installation acceptance testing
Corrective Action Required
02/06/2024

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule testing.
Sprinkler Plan Review Rejected 11/22/2023 11/27/2023
Jim Eden
Construction documents - Fire protection systems
Corrective Action Required
11/27/2023

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. Received stamped plans 11/8/2023.
Installation acceptance testing
Corrective Action Required
11/27/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule hydrostatic and flow tests.
Miscellaneous Correction
Corrective Action Required
11/27/2023

The civil plans call for the backflow to be in a vault in the yard to serve the sprinkler and private hydrant. Action requred- Confirm
Miscellaneous Correction
Corrective Action Required
11/27/2023

The plans call for the main to be piped to the exterior. Action required- How do you plan to do this? Will it be piped to a suitable drain capable of handling a full flow test?
Miscellaneous Correction
Corrective Action Required
11/27/2023

If the backflow is moved to the vault, a one way check valve is required at the base of the riser.
Licensed Contractors Approved 12/13/2021 07/21/2022
Mike Weisenborn
LC - General Contractor
Resolved
07/21/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact. 12/6/21 - acknowledged in letter.
LC - MEP Subs
Resolved
07/21/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 12/6/21 - acknowledged in letter.
Final Development Plan Review Approved 06/28/2022
Mike Weisenborn
Building Plan Review Approved 12/13/2021 03/18/2022
Joe Frogge
Final Development Plan
Resolved
01/13/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 12/6/21 - acknowledged in letter.
IMC 306.5 Equipment on roofs
Resolved
12/06/2021

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide side rail extender at roof hatch.
IPC 502.1 Water heater manufacturers installation instructions
Resolved
12/06/2021

2018 IPC 502.1 General. Water heaters shall be installed in accordance with the manufacturer’s installation instructions. Oil-fired water heaters shall conform to the requirements of this code and the International Mechanical Code. Electric water heaters shall conform to the requirements of this code and provisions of NFPA 70. Gas-fired water heaters shall conform to the requirements of the International Fuel Gas Code. Action required: Provide expansion tank at water heater or provide verification that water heater installed will not require expansion tank in the manufacturer's written instructions.
Fire Plan Review Approved with Conditions 12/13/2021 12/07/2021
Michael Weissenbach
Construction documents for fire alarm systems
Corrective Action Required
12/06/2021

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. (Action Required) Provide PE stamped electronic shop drawings for the fire alarm system to mike.weissenbach@cityofls.net
Address numbers required
Corrective Action Required
12/06/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Corrective Action Required
12/06/2021

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Action Required) Order a Knox Box from knoxbox.com. Placement to be made by the FDC.
Construction documents - Fire protection systems
Corrective Action Required
12/06/2021

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. (Action Required) Provide PE stamped electronic shop drawings for the fire sprinkler system to mike.weissenbach@cityofls.net
Installation acceptance testing
Corrective Action Required
12/06/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Illumination required
Resolved
12/07/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required) Provide exit/emergency lighting out of estimating space.
Building Plan Review Rejected 11/05/2021 10/26/2021
Joe Frogge
Final Development Plan
Corrective Action Required
10/26/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
IMC 306.5 Equipment on roofs
Corrective Action Required
10/26/2021

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide side rail extender at roof hatch.
IPC 502.1 Water heater manufacturers installation instructions
Corrective Action Required
10/26/2021

2018 IPC 502.1 General. Water heaters shall be installed in accordance with the manufacturer’s installation instructions. Oil-fired water heaters shall conform to the requirements of this code and the International Mechanical Code. Electric water heaters shall conform to the requirements of this code and provisions of NFPA 70. Gas-fired water heaters shall conform to the requirements of the International Fuel Gas Code. Action required: Provide expansion tank at water heater or provide verification that water heater installed will not require expansion tank in the manufacturer's written instructions.
Licensed Contractors Rejected 10/22/2021 10/25/2021
Joe Frogge
LC - General Contractor
Corrective Action Required
10/25/2021

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact.
LC - MEP Subs
Corrective Action Required
10/25/2021

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fire Plan Review Approved with Conditions 11/05/2021 10/25/2021
Michael Weissenbach
Construction documents for fire alarm systems
Corrective Action Required
10/25/2021

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. (Action Required) Provide PE stamped electronic shop drawings for the fire alarm system to mike.weissenbach@cityofls.net
Address numbers required
Corrective Action Required
10/25/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Corrective Action Required
10/25/2021

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Action Required) Order a Knox Box from knoxbox.com. Placement to be made by the FDC.
Construction documents - Fire protection systems
Corrective Action Required
10/25/2021

2018 IFC 901.2- Construction documents. The fire code official shall have the authority to require construction documents and calculations for all fire protection systems and to require permits be issued for the installation, rehabilitation or modification of any fire protection system. Construction documents for fire protection systems shall be submitted for review and approval prior to system installation. (Action Required) Provide PE stamped electronic shop drawings for the fire sprinkler system to mike.weissenbach@cityofls.net
Installation acceptance testing
Corrective Action Required
10/25/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Illumination required
Corrective Action Required
10/25/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required) Provide exit/emergency lighting out of estimating space.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $9,000.00 $9,000.00 Paid 02/02/2023
$15,135.00
8331507-Sewer Connection Fee $360.00 $360.00 Paid 02/02/2023
7232302-Commercial Excise Tax Fee $15,135.00 $15,135.00 Paid 10/25/2021
$15,135.00
7232302-Commercial Excise Tax Fee $18,915.00 $18,915.00 Paid 02/02/2023
$15,135.00
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 02/02/2023
9110081-Paved Surface Inspection Fee $2,128.67 $2,128.67 Paid 02/02/2023
91100C9-Water Insp Fee $582.30 $582.30 Paid 02/02/2023
91100C8-Sanitary Sewer Insp Fees $1,759.65 $1,759.65 Paid 02/02/2023
9110072-Water Test Fee $400.00 $400.00 Paid 02/02/2023
9110071-Site Grading Fee $1,266.18 $1,266.18 Paid 02/02/2023
9110069-After Hours Inspections (Public Works)(Per Hour) $200.00 $200.00 Paid 12/20/2023
8331401-Water Tap Fee $2,510.00 $2,510.00 Paid 12/20/2023
$10,030.00
8350015-Water Meter Fee $1,643.84 $1,643.84 Paid 12/20/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 03/06/2024
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 07/21/2022
Misc
Informational
07/21/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week.
Site Visit Partial 07/25/2022
Misc
Informational
07/21/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet.
Site Visit Partial 07/28/2022
Misc
Informational
07/25/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site.
Site Visit Partial 07/29/2022
Misc
Informational
07/28/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Erosion Control Inspection Partial 08/02/2022
Misc
Informational
08/02/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES
Site Visit Partial 08/02/2022
Misc
Informational
07/29/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/02/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES
Site Visit Partial 08/03/2022
Misc
Informational
08/02/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/02/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES
Site Visit Partial 08/04/2022
Misc
Informational
08/03/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/03/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today.
Site Visit Partial 08/05/2022
Misc
Informational
08/04/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/04/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM.
Site Visit Partial 08/08/2022
Misc
Informational
08/05/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/05/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM.
Erosion Control Inspection Partial 08/08/2022
Misc
Informational
08/02/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order.
Site Visit Partial 08/09/2022
Misc
Informational
08/08/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/08/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development.
Site Visit Partial 08/10/2022
Misc
Informational
08/09/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/09/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today.
Site Visit Partial 08/11/2022
Misc
Informational
08/10/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/10/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today.
Site Visit Partial 08/12/2022
Misc
Informational
08/11/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/11/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad.
Site Visit Partial 08/15/2022
Misc
Informational
08/12/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/12/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed.
Erosion Control Inspection Partial 08/15/2022
Misc
Informational
08/08/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order.
Site Visit Partial 08/16/2022
Misc
Informational
08/15/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/15/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well.
Site Visit Partial 08/17/2022
Misc
Informational
08/16/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/16/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today.
Site Visit Partial 08/18/2022
Misc
Informational
08/17/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/17/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today.
Site Visit Partial 08/19/2022
Misc
Informational
08/18/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/18/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today.
Site Visit Partial 08/22/2022
Misc
Informational
08/19/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/19/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today.
Erosion Control Inspection Partial 08/22/2022
Misc
Informational
08/15/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order.
Site Visit Partial 08/23/2022
Misc
Informational
08/22/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/22/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development.
Site Visit Partial 08/24/2022
Misc
Informational
08/23/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/23/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development.
Site Visit Partial 08/29/2022
Misc
Informational
08/24/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/24/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22.
Erosion Control Inspection Partial 08/29/2022
Misc
Informational
08/22/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order.
Site Visit Partial 09/02/2022
Misc
Informational
08/29/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/29/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22.
Erosion Control Inspection Partial 09/06/2022
Misc
Informational
08/29/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order.
Site Visit Partial 09/06/2022
Misc
Informational
09/02/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/02/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22.
Site Visit Partial 09/09/2022
Misc
Informational
09/06/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/06/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22.
Site Visit Partial 09/12/2022
Misc
Informational
09/09/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/09/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development today.
Erosion Control Inspection Partial 09/12/2022
Misc
Informational
09/06/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order.
Erosion Control Inspection Partial 09/19/2022
Misc
Informational
09/12/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order.
Site Visit Partial 09/26/2022
Misc
Informational
09/12/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/12/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22.
Erosion Control Inspection Partial 09/26/2022
Misc
Informational
09/19/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order.
Erosion Control Inspection Partial 10/3/2022 10/03/2022
Misc
Informational
09/26/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order.
Site Visit Partial 10/7/2022 10/07/2022
Misc
Informational
09/26/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/26/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate.
Erosion Control Inspection Partial 10/11/2022 10/11/2022
Misc
Informational
10/03/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order.
Erosion Control Inspection Partial 10/24/2022 10/24/2022
Misc
Informational
10/11/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order.
Site Visit Partial 10/24/2022 10/24/2022
Misc
Informational
10/07/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/07/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank.
Site Visit Partial 10/25/2022 10/25/2022
Misc
Informational
10/24/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/24/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22.
Erosion Control Inspection Partial 10/31/2023 10/31/2022
Misc
Informational
10/24/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order.
Erosion Control Inspection Partial 11/7/2022 11/07/2022
Misc
Informational
10/31/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order. 11-7-22 RH. Erosion control is up and in working order.
Site Visit Partial 11/7/2022 11/07/2022
Misc
Informational
10/25/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/25/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon.
Pavement-Aggregate Base Partial 11/10/2022 11/10/2022
Misc
Informational
11/10/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed.
Erosion Control Inspection Partial 11/14/2022 11/14/2022
Misc
Informational
11/07/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order. 11-7-22 RH. Erosion control is up and in working order. 11-14-22 RH. Erosion control is up and in working order.
Site Visit Partial 11/14/2022 11/14/2022
Misc
Informational
11/07/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/07/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today.
Pavement-Aggregate Base Partial 11/17/2022 11/17/2022
Misc
Informational
11/10/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed. 11-17-22 RH. Still waiting for weather to be warmer before placing grid and aggregate. Weather is to cold to work on parking lot.
Pavement-Aggregate Base Partial 11/21/2022 11/21/2022
Misc
Informational
11/17/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed. 11-17-22 RH. Still waiting for weather to be warmer before placing grid and aggregate. Weather is to cold to work on parking lot. 11-21-22 RH. Once parking was at final grade contractor started laying down geo grid and aggregate base. Base was rolled in as it was placed. Proof roll will be scheduled for tomorrow.
Pavement-Aggregate Base Partial 11/22/2022 11/22/2022
Misc
Informational
11/21/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed. 11-17-22 RH. Still waiting for weather to be warmer before placing grid and aggregate. Weather is to cold to work on parking lot. 11-21-22 RH. Once parking was at final grade contractor started laying down geo grid and aggregate base. Base was rolled in as it was placed. Proof roll will be scheduled for tomorrow. 11-22-22 RH. Contractor continues to place aggregate and Geogrid. Proof roll will be completed once all aggregate is rolled in.
Pavement-Aggregate Base Partial 11/23/2022 11/23/2022
Misc
Informational
11/22/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed. 11-17-22 RH. Still waiting for weather to be warmer before placing grid and aggregate. Weather is to cold to work on parking lot. 11-21-22 RH. Once parking was at final grade contractor started laying down geo grid and aggregate base. Base was rolled in as it was placed. Proof roll will be scheduled for tomorrow. 11-22-22 RH. Contractor continues to place aggregate and Geogrid. Proof roll will be completed once all aggregate is rolled in. 11-23-22 RH. Contractor completed placing Geogrid and aggregate.
Pavement-Proof Roll Partial 11/23/2022 11/23/2022
Misc
Informational
11/23/2022
11-23-22 RH. A 21 ton loaded truck rolled over aggregate sub grade. North and south of building passed while the East and West side of the building will need reworked due to pumping and rutting.
Erosion Control Inspection Partial 11/28/2022 11/28/2022
Misc
Informational
11/14/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order. 11-7-22 RH. Erosion control is up and in working order. 11-14-22 RH. Erosion control is up and in working order. 11-28-22 RH. Erosion control is up and in working order.
Pavement-Proof Roll Partial 11/28/2022 11/28/2022
Misc
Informational
11/23/2022
11-23-22 RH. A 21 ton loaded truck rolled over aggregate sub grade. North and south of building passed while the East and West side of the building will need reworked due to pumping and rutting. 11-28-22 RH. Proof roll was moved to tomorrow due to how wet subgrade is from the rain.
Pavement-Proof Roll Passed 12/5/2022 12/05/2022
Misc
Informational
11/28/2022
11-23-22 RH. A 21 ton loaded truck rolled over aggregate sub grade. North and south of building passed while the East and West side of the building will need reworked due to pumping and rutting. 11-28-22 RH. Proof roll was moved to tomorrow due to how wet subgrade is from the rain.
Misc
Informational
12/05/2022
On Monday, 12-05-2022, I preformed a visual inspection of the pavement for the proof roll and found it to be visually sound. There were a few areas that were questionable. However the contractor came with the agreement to place reinforcing rebar for those questionable areas. The pavement area is to small to adequately perform a proof roll with a 20 ton dump truck without causing more damage to the sub-base. The sub-grade was passed for placement of concrete with pending rain coming in the forecast.
Pavement-Aggregate Base Passed 12/8/2022 12/08/2022
Misc
Informational
11/23/2022
11-10-22 RH. The old parking lot was cut out from around new building. Grade was being cut down where old asphalt was. Once the grade is cut down to final grade the Geogrid will be placed. 11-17-22 RH. Still waiting for weather to be warmer before placing grid and aggregate. Weather is to cold to work on parking lot. 11-21-22 RH. Once parking was at final grade contractor started laying down geo grid and aggregate base. Base was rolled in as it was placed. Proof roll will be scheduled for tomorrow. 11-22-22 RH. Contractor continues to place aggregate and Geogrid. Proof roll will be completed once all aggregate is rolled in. 11-23-22 RH. Contractor completed placing Geogrid and aggregate.
Misc
Informational
12/08/2022
On Wednesday,12-07-2022 I performed a 6” concrete reinforce pavement inspection for the parking lot. The contractor poured approx 100 cy of 4500 psi concrete around the enter walls of the building.
Site Visit Partial 2/13/2023 2/13/2023 02/13/2023
Misc
Informational
11/14/2022
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/14/2022
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site
Site Visit Partial 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
02/13/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
02/13/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project
Site Visit Partial 3/22/2023 3/22/2023 03/22/2023
Misc
Informational
03/17/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/17/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project
Site Visit Partial 3/23/2023 3/23/2023 03/23/2023
Misc
Informational
03/22/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/22/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project
Site Visit Partial 3/31/2023 3/31/2023 03/31/2023
Misc
Informational
03/23/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/23/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project
Site Visit Partial 4/11/2023 4/11/2023 04/11/2023
Misc
Informational
03/31/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/31/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project
Site Visit Partial 5/15/2023 5/15/2023 05/15/2023
Misc
Informational
04/11/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
04/11/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd
Site Visit Partial 5/19/2023 5/19/2023 05/19/2023
Misc
Informational
05/15/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/15/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week.
Site Visit Partial 5/23/2023 5/23/2023 05/23/2023
Misc
Informational
05/19/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/19/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week.
Site Visit Partial 5/24/2023 5/24/2023 05/24/2023
Misc
Informational
05/23/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/23/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building
Site Visit Partial 5/25/2023 5/25/2023 05/25/2023
Misc
Informational
05/24/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/24/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site
Site Visit Partial 5/26/2023 5/26/2023 05/26/2023
Misc
Informational
05/25/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/25/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site
Site Visit Partial 5/30/2023 5/30/2023 05/30/2023
Misc
Informational
05/26/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/26/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site
Site Visit Partial 5/31/2023 5/31/2023 05/31/2023
Misc
Informational
05/30/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/30/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather
Site Visit Partial 6/1/2023 6/1/2023 06/01/2023
Misc
Informational
05/31/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
05/31/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site
Site Visit Partial 6/2/2023 6/2/2023 06/02/2023
Misc
Informational
06/01/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/01/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was.
Site Visit Partial 6/5/2023 6/5/2023 06/05/2023
Misc
Informational
06/02/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/02/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD
Site Visit Partial 6/6/2023 6/6/2023 06/06/2023
Misc
Informational
06/05/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/05/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building
Site Visit Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/06/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/06/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building
Site Visit Partial 6/14/2023 6/14/2023 06/14/2023
Misc
Informational
06/07/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/07/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase
Erosion Control Inspection Partial 6/19/2023 6/19/2023 06/19/2023
Misc
Informational
11/28/2022
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order. 11-7-22 RH. Erosion control is up and in working order. 11-14-22 RH. Erosion control is up and in working order. 11-28-22 RH. Erosion control is up and in working order. 6-19-23 PS Existing building A has been demolished with site ready for construction of new building. Erosion control on perimeter and construction entry needed before new site work begins.
Grading/Excavation/Fill Inspection Partial 6/21/2023 6/21/2023 06/21/2023
Misc
Informational
06/21/2023
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site
Grading/Excavation/Fill Inspection Partial 6/22/2023 6/22/2023 06/22/2023
Misc
Informational
06/22/2023
6-22-23 PS Contractor on site performing site grading for building pad and removing soil from site
Grading/Excavation/Fill Inspection Partial 6/23/2023 6/23/2023 06/23/2023
Misc
Informational
06/22/2023
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site 6-23-23 PS Contractor grading at site for building pad
Grading/Excavation/Fill Inspection Partial 6/26/2023 6/26/2023 06/26/2023
Misc
Informational
06/23/2023
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site 6-23-23 PS Contractor grading at site for building pad 6-26-23 PS Contractor grading at site for building pad
Erosion Control Inspection Failed 6/28/2023 6/28/2023 06/28/2023
Misc
Corrective Action Required
06/28/2023
6-28-23 PS Install all erosion control methods per approved plans on site
ESC - (Vegetation/Ground Cover) Partial 6/29/2023 6/29/2023 06/29/2023
Misc
Informational
06/29/2023
6/29/23 PS - Met Andrew with Rose Construction on site. Discussed install and locations of erosion control. Contractor expected to have erosion control installed ASAP.
Grading/Excavation/Fill Inspection Partial 6/30/2023 6/30/2023 06/30/2023
Misc
Informational
06/26/2023
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site 6-23-23 PS Contractor grading at site for building pad 6-26-23 PS Contractor grading at site for building pad 6-30-23 PS Crew preparing site for building footing
Site Visit Partial 7/3/2023 7/3/2023 07/03/2023
Misc
Informational
06/14/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
06/14/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today
Erosion Control Inspection Partial 7/6/2023 7/6/2023 07/06/2023
Misc
Informational
06/19/2023
Erosion control measures in place and appear to be functioning. 8/2/22 ES 8-8-22 RH. Erosion Control is up and in working order. 8-15-22 RH. Erosion control is up and in working order. 8-22-22 RH. Erosion control is up and in working order. 8-29-22 RH. Erosion control is up and in working order. 9-6-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-19-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion Control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order. 11-7-22 RH. Erosion control is up and in working order. 11-14-22 RH. Erosion control is up and in working order. 11-28-22 RH. Erosion control is up and in working order. 6-19-23 PS Existing building A has been demolished with site ready for construction of new building. Erosion control on perimeter and construction entry needed before new site work begins. 7-6-23 PS Spoke with Andrew with Rose construction, waiting on utility marking before Gordon Energy can place silt fence. Expected wither by end of week or early next week. Contractor obtaining straw swaddles to place on west side
Footing Inspection - Commercial Failed 7/10/2023 (10:00) 7/10/2023 07/10/2023
Footing Inspection - Commercial Partial 7/11/2023 (10:00) 7/11/2023 07/11/2023
Misc
Informational
07/11/2023
- inspected west side 1A to 7A AND 7A-1-2, UFER IN PLACE
Site Visit Partial 7/11/2023 7/11/2023 07/11/2023
Misc
Informational
07/03/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/03/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad
Site Visit Partial 7/12/2023 7/12/2023 07/12/2023
Misc
Informational
07/11/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/11/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing
Erosion Control Inspection Partial 7/13/2023 7/13/2023 07/13/2023
Misc
Corrective Action Required
07/06/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection
Site Visit Partial 7/14/2023 7/14/2023 07/14/2023
Misc
Informational
07/12/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/12/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing
Site Visit Partial 7/17/2023 7/17/2023 07/17/2023
Misc
Informational
07/14/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/14/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing
Erosion Control Inspection Partial 7/17/2023 7/17/2023 07/17/2023
Misc
Corrective Action Required
07/13/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection
Footing Inspection - Commercial Passed 7/18/2023 (9:00) 7/18/2023 07/18/2023
Misc
Informational
07/11/2023
- inspected west side 1A to 7A AND 7A-1-2, UFER IN PLACE
Erosion Control Inspection Partial 7/18/2023 7/18/2023 07/18/2023
Misc
Corrective Action Required
07/17/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection
Erosion Control Inspection Partial 7/19/2023 7/19/2023 07/19/2023
Misc
Corrective Action Required
07/18/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection
Erosion Control Inspection Partial 7/21/2023 7/21/2023 07/21/2023
Misc
Corrective Action Required
07/19/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 7/24/2023 7/24/2023 07/24/2023
Misc
Corrective Action Required
07/21/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 7/25/2023 7/25/2023 07/25/2023
Misc
Corrective Action Required
07/24/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 7/27/2023 7/27/2023 07/27/2023
Misc
Informational
07/17/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/17/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site
Erosion Control Inspection Partial 7/31/2023 7/31/2023 07/31/2023
Misc
Corrective Action Required
07/25/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 8/1/2023 8/1/2023 08/01/2023
Misc
Corrective Action Required
07/31/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/2/2023 8/2/2023 08/02/2023
Misc
Informational
07/27/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
07/27/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site
Erosion Control Inspection Partial 8/3/2023 8/3/2023 08/03/2023
Misc
Corrective Action Required
08/01/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/4/2023 8/4/2023 08/04/2023
Misc
Informational
08/02/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/02/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site
Erosion Control Inspection Partial 8/7/2023 8/7/2023 08/07/2023
Misc
Corrective Action Required
08/03/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/7/2023 8/7/2023 08/07/2023
Misc
Informational
08/04/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/04/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site
Site Visit Partial 8/9/2023 8/9/2023 08/09/2023
Misc
Informational
08/07/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/07/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site
Erosion Control Inspection Partial 8/9/2023 8/9/2023 08/09/2023
Misc
Corrective Action Required
08/07/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/10/2023 8/10/2023 08/10/2023
Misc
Informational
08/09/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/09/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site
Site Visit Partial 8/11/2023 8/11/2023 08/11/2023
Misc
Informational
08/10/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/10/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site
Erosion Control Inspection Partial 8/11/2023 8/11/2023 08/11/2023
Misc
Corrective Action Required
08/09/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 8/14/2023 8/14/2023 08/14/2023
Misc
Corrective Action Required
08/11/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/14/2023 8/14/2023 08/14/2023
Misc
Informational
08/11/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/11/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site
Site Visit Partial 8/15/2023 8/15/2023 08/15/2023
Misc
Informational
08/14/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/14/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site
Site Visit Partial 8/16/2023 8/16/2023 08/16/2023
Misc
Informational
08/15/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/15/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site
Erosion Control Inspection Partial 8/16/2023 8/16/2023 08/16/2023
Misc
Corrective Action Required
08/14/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/18/2023 8/18/2023 08/18/2023
Misc
Informational
08/16/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/16/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site
Erosion Control Inspection Partial 8/21/2023 8/21/2023 08/21/2023
Misc
Corrective Action Required
08/16/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/21/2023 8/21/2023 08/21/2023
Misc
Informational
08/18/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/18/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today
Site Visit Partial 8/22/2023 8/22/2023 08/22/2023
Misc
Informational
08/21/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/21/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today
Site Visit Partial 8/24/2023 8/24/2023 08/24/2023
Misc
Informational
08/22/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/22/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today
Site Visit Partial 8/25/2023 8/25/2023 08/25/2023
Misc
Informational
08/24/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/24/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today
Erosion Control Inspection Partial 8/30/2023 8/30/2023 08/30/2023
Misc
Corrective Action Required
08/21/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 8/31/2023 8/31/2023 08/31/2023
Misc
Informational
08/25/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/25/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels
Site Visit Partial 9/6/2023 9/6/2023 09/06/2023
Misc
Informational
08/31/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
08/31/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls
Erosion Control Inspection Partial 9/6/2023 9/6/2023 09/06/2023
Misc
Corrective Action Required
08/30/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 9/8/2023 9/8/2023 09/08/2023
Misc
Informational
09/06/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/06/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls
Site Visit Partial 9/11/2023 9/11/2023 09/11/2023
Misc
Informational
09/08/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/08/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls
Erosion Control Inspection Partial 9/11/2023 9/11/2023 09/11/2023
Misc
Corrective Action Required
09/06/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 9/13/2023 9/13/2023 09/13/2023
Misc
Informational
09/11/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/11/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls
Site Visit Partial 9/14/2023 9/14/2023 09/14/2023
Misc
Informational
09/13/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/13/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls
Site Visit Partial 9/15/2023 9/15/2023 09/15/2023
Misc
Informational
09/14/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/14/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell
Site Visit Partial 9/20/2023 9/20/2023 09/20/2023
Misc
Informational
09/15/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/15/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary)
Erosion Control Inspection Partial 9/20/2023 9/20/2023 09/20/2023
Misc
Corrective Action Required
09/11/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection
Underslab Electrical Inspection - Commercial Partial 9/20/2023 09/20/2023
Misc
Corrective Action Required
09/20/2023
Complete from vehicle bay south
Underslab Plumbing Inspection - Commercial Passed 9/25/2023 9/25/2023 09/25/2023
Erosion Control Inspection Partial 9/25/2023 9/25/2023 09/25/2023
Misc
Corrective Action Required
09/20/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection
Water Line - Construction Inspection Partial 9/29/2023 9/29/2023 09/29/2023
Misc
Informational
09/29/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building.
Erosion Control Inspection Partial 10/2/2023 10/2/2023 10/02/2023
Misc
Corrective Action Required
09/25/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection
Underslab Plumbing Inspection - Commercial Passed 10/3/2023 10/3/2023 10/03/2023
Underslab Electrical Inspection - Commercial Passed 10/3/2023 10/3/2023 10/03/2023
Misc
Resolved
10/03/2023
Complete from vehicle bay south
Site Visit Partial 10/5/2023 10/5/2023 10/05/2023
Misc
Informational
09/20/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
09/20/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development
Erosion Control Inspection Partial 10/11/2023 10/11/2023 10/11/2023
Misc
Corrective Action Required
10/02/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection
Site Visit Partial 10/12/2023 10/12/2023 10/12/2023
Misc
Informational
10/05/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/05/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development
Site Visit Partial 10/16/2023 10/16/2023 10/16/2023
Misc
Informational
10/12/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/12/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab
Site Visit Partial 10/17/2023 10/17/2023 10/17/2023
Misc
Informational
10/16/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/16/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab
Pavement-Aggregate Base Partial 10/19/2023 10/19/2023 10/19/2023
Misc
Informational
10/19/2023
10-19-23 PS Contractor grading and preparing grade for aggregate base for concrete drive at south end of building A
Pavement-Proof Roll Partial 10/20/2023 10/20/2023 10/20/2023
Misc
Informational
10/20/2023
10-20-23 PS Contractor performed proof roll on aggregate base for concrete located at rear south side of building "A" between existing building. Areas inspected approved to pour concrete
Pavement-Surface Partial 10/23/2023 10/23/2023 10/23/2023
Misc
Informational
10/23/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building.
Pavement-Surface Partial 10/23/2023 10/23/2023 10/23/2023
Misc
Informational
10/23/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection
Erosion Control Inspection Partial 10/24/2023 10/24/2023 10/24/2023
Misc
Corrective Action Required
10/11/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 10/27/2023 10/27/2023 10/27/2023
Misc
Corrective Action Required
10/24/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection
Sewer Service Inspection Partial 10/30/2023 10/30/2023 10/30/2023
Misc
Informational
10/30/2023
10-30-23 PS Contractor installed sanitary service line from building on east side turning corner at front north side for partial. Oil/sand interceptor installed and meets plan requirements, 4" cleanouts installed on both sides of interceptor. Contractor omitted grinder pump as he was able to achieve required fall.
Site Visit Partial 10/31/2023 10/31/2023 10/31/2023
Misc
Informational
10/17/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/17/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today
Pavement-Aggregate Base Partial 11/1/2023 11/1/2023 11/01/2023
Misc
Informational
10/19/2023
10-19-23 PS Contractor grading and preparing grade for aggregate base for concrete drive at south end of building A 11-1-23 PS Inspected geo grid at new parking lot section for asphalt on north side. Contractor installed terragrid RX1200 model from approved list. Contractor placing aggregate on top of geo grid and compacting.
Pavement-Proof Roll Partial 11/2/2023 11/2/2023 11/02/2023
Misc
Informational
10/20/2023
10-20-23 PS Contractor performed proof roll on aggregate base for concrete located at rear south side of building "A" between existing building. Areas inspected approved to pour concrete 11-2-23 PS Inspected proof roll on NE side of parking lot where new asphalt will be placed at parking stalls. Approved for surface.
Curb - Proof Roll Partial 11/2/2023 11/2/2023 11/02/2023
Misc
Informational
11/02/2023
11-2-23 PS Inspected proof roll on NE side of parking lot where new curbs will be placed at parking stalls. Approved to pour curbs
In-wall Inspection Partial 11/2/2023 11/2/2023 11/02/2023
Misc
Corrective Action Required
11/02/2023
11/2/23 -OK to rock north side of estimating wall only **Complete all other framing and all MEPs for in wall inspection
Pavement-Proof Roll Partial 11/2/2023 11/2/2023 11/02/2023
Misc
Informational
11/02/2023
10-20-23 PS Contractor performed proof roll on aggregate base for concrete located at rear south side of building "A" between existing building. Areas inspected approved to pour concrete 11-2-23 PS Inspected proof roll on NE side of parking lot where new asphalt will be placed at parking stalls. Approved for surface. PM Inspected proof rol at NE side of new lot for concrete surface at garage bay. Area inspected approved for surface
Pavement-Curb Construction Partial 11/3/2023 11/3/2023 11/03/2023
Misc
Informational
11/03/2023
11-3-23 PS Contractor poured curbs at new parking lot stalls NW side
Pavement-Surface Partial 11/3/2023 11/3/2023 11/03/2023
Misc
Informational
10/23/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building
Pavement-Surface Partial 11/3/2023 11/3/2023 11/03/2023
Misc
Informational
11/03/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building. PM contractor completed pour and was brushing finish at reinspection
Pavement-Curb Construction Partial 11/3/2023 11/3/2023 11/03/2023
Misc
Informational
11/03/2023
11-3-23 PS Contractor poured curbs at new parking lot stalls NW side. PM contractor completed pour this afternoon and was brushing finish at reinspection
Pavement-Curb Construction Partial 11/6/2023 11/6/2023 11/06/2023
Misc
Informational
11/03/2023
11-3-23 PS Contractor poured curbs at new parking lot stalls NW side. PM contractor completed pour this afternoon and was brushing finish at reinspection 11-6-23 PS Contractor completed new curb construction on east side of building
Site Visit Partial 11/7/2023 11/7/2023 11/07/2023
Misc
Informational
10/31/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
10/31/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in
Pavement-Surface Partial 11/8/2023 11/8/2023 11/08/2023
Misc
Informational
11/03/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building. PM contractor completed pour and was brushing finish at reinspection 11-8-23 PS Asphalt contractor milling surface of existing asphalt at parking lot and preparring f surface tomorrow. Potholes and damaged areas of existing surface removed for new base.
Sidewalk Inspection Partial 11/9/2023 11/9/2023 11/09/2023
Misc
Informational
11/09/2023
11-9-23 PS Performed private sidewalk pre pour inspection. Sidewalk is on NE side of building in front of new parking lot stalls. Forms in place and aggregate compacted. OK to pour
Pavement-Surface Partial 11/9/2023 11/9/2023 11/09/2023
Misc
Informational
11/08/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building. PM contractor completed pour and was brushing finish at reinspection 11-8-23 PS Asphalt contractor milling surface of existing asphalt at parking lot and preparring f surface tomorrow. Potholes and damaged areas of existing surface removed for new base. 11-9-23 PS Contractor spreading and rolling surface asphalt. Contractor expects to complete half of parking lot on west side today and other half tomorrow for business operations. Surface temp 62 degrees and air temp 51 degrees and climbing at time of inspection
Pavement-Surface Partial 11/10/2023 11/10/2023 11/10/2023
Misc
Informational
11/09/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building. PM contractor completed pour and was brushing finish at reinspection 11-8-23 PS Asphalt contractor milling surface of existing asphalt at parking lot and preparing for surface tomorrow. Potholes and damaged areas of existing surface removed for new base. 11-9-23 PS Contractor spreading and rolling surface asphalt. Contractor expects to complete half of parking lot on west side today and other half tomorrow for business operations. Surface temp 62 degrees and air temp 51 degrees and climbing at time of inspection 11-10-23 PS Contractor spreading and rolling surface asphalt on east side of seam for parking lot surface completetion. Temps acceptable.
Site Visit Partial 11/13/2023 11/13/2023 11/13/2023
Misc
Informational
11/07/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/07/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped
Site Visit Partial 11/14/2023 11/14/2023 11/14/2023
Misc
Informational
11/13/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/13/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped 11-14-23 PS Crews working on building interior. No work for development
Erosion Control Inspection Partial 11/21/2023 11/21/2023 11/21/2023
Misc
Corrective Action Required
10/27/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection
Sidewalk Inspection Partial 11/21/2023 11/21/2023 11/21/2023
Misc
Informational
11/09/2023
11-9-23 PS Performed private sidewalk pre pour inspection. Sidewalk is on NE side of building in front of new parking lot stalls. Forms in place and aggregate compacted. OK to pour 11-21-23 PS Contractor pouring private sidewalk at front east side of building
Site Visit Partial 11/27/2023 11/27/2023 11/27/2023
Misc
Informational
11/14/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/14/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped. 11-14-23 PS Crews working on building interior. No work for development 11-27-23 PS Met with plumbing contractor to distribute notices for water shutdown for tie in on 11/30
Erosion Control Inspection Partial 11/27/2023 11/27/2023 11/27/2023
Misc
Corrective Action Required
11/21/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection
Water Line - Construction Inspection Partial 11/30/2023 11/30/2023 11/30/2023
Misc
Informational
09/29/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee
Erosion Control Inspection Partial 12/4/2023 12/4/2023 12/04/2023
Misc
Corrective Action Required
11/27/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection
Water Line - Construction Inspection Partial 12/5/2023 12/5/2023 12/05/2023
Misc
Informational
11/30/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault
In-wall Inspection Passed 12/6/2023 12/06/2023
Misc
Resolved
12/06/2023
11/2/23 -OK to rock north side of estimating wall only **Complete all other framing and all MEPs for in wall inspection
All Rough Inspection - Commercial Passed 12/6/2023 12/6/2023 12/06/2023
Water Line - Construction Inspection Partial 12/6/2023 12/6/2023 12/06/2023
Misc
Informational
12/05/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault
Water Line - Construction Inspection Partial 12/6/2023 12/6/2023 12/06/2023
Misc
Informational
12/06/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault
Water Line - Construction Inspection Partial 12/7/2023 12/7/2023 12/07/2023
Misc
Informational
12/06/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installedfor hydrant after backflow
Water Line - Construction Inspection Partial 12/7/2023 12/7/2023 12/07/2023
Misc
Informational
12/07/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installed for hydrant after backflow. PM contractor installing line from tee on south side of backflow towards where hydrant will be placed. Thrust block poured at tee, vault ductile penetrations have been grouted
Water Line - Construction Inspection Partial 12/8/2023 12/8/2023 12/08/2023
Misc
Informational
12/07/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installed for hydrant after backflow. PM contractor installing line from tee on south side of backflow towards where hydrant will be placed. Thrust block poured at tee, vault ductile penetrations have been grouted 12-8-23 PS Contractor backfilled areas from prior inspections, private hydrant has been set with thrust block, thrust block poured at ductile at north side line entrance to vault
Water Line - Construction Inspection Partial 12/8/2023 12/8/2023 12/08/2023
Misc
Informational
12/08/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installed for hydrant after backflow. PM contractor installing line from tee on south side of backflow towards where hydrant will be placed. Thrust block poured at tee, vault ductile penetrations have been grouted 12-8-23 PS Contractor backfilled areas from prior inspections, private hydrant has been set with thrust block, thrust block poured at ductile at north side line entrance to vault. PM Contractor backfilled remainder of line at hydrant and backfilled at vault
Sewer Service Inspection Passed 12/11/2023 12/11/2023 12/11/2023
Misc
Informational
10/30/2023
10-30-23 PS Contractor installed sanitary service line from building on east side turning corner at front north side for partial. Oil/sand interceptor installed and meets plan requirements, 4" cleanouts installed on both sides of interceptor. Contractor omitted grinder pump as he was able to achieve required fall. 12-11-23 PS Contractor completed sanitary
Water Line - Construction Inspection Partial 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
12/08/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installed for hydrant after backflow. PM contractor installing line from tee on south side of backflow towards where hydrant will be placed. Thrust block poured at tee, vault ductile penetrations have been grouted 12-8-23 PS Contractor backfilled areas from prior inspections, private hydrant has been set with thrust block, thrust block poured at ductile at north side line entrance to vault. PM Contractor backfilled remainder of line at hydrant and backfilled at vault 12-12-23 PS Contractor completed line flush of fire line from main to riser. Contractor also flushed fire line at private hydrant
Fire Line - Hydrostatic Test Partial 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
12/12/2023
12-12-23 PS Contractor performing hydrostatic test on fireline, test started 10:30 AM
Pavement-Aggregate Base Passed 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
11/01/2023
10-19-23 PS Contractor grading and preparing grade for aggregate base for concrete drive at south end of building A 11-1-23 PS Inspected geo grid at new parking lot section for asphalt on north side. Contractor installed terragrid RX1200 model from approved list. Contractor placing aggregate on top of geo grid and compacting.
Pavement-Proof Roll Passed 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
11/02/2023
10-20-23 PS Contractor performed proof roll on aggregate base for concrete located at rear south side of building "A" between existing building. Areas inspected approved to pour concrete 11-2-23 PS Inspected proof roll on NE side of parking lot where new asphalt will be placed at parking stalls. Approved for surface. PM Inspected proof rol at NE side of new lot for concrete surface at garage bay. Area inspected approved for surface
Curb - Proof Roll Passed 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
11/02/2023
11-2-23 PS Inspected proof roll on NE side of parking lot where new curbs will be placed at parking stalls. Approved to pour curbs
Pavement-Surface Passed 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
11/10/2023
10-23-23 PS Contractor pouring concrete for parking lot at rear south side of building "A" between existing building. P.M. Contractor completed concrete pour and was completing brush finish at inspection 11-3-23 PS Contractor pouring concrete at NE side of new parking lot at sliding door stall and small path along east side of building. PM contractor completed pour and was brushing finish at reinspection 11-8-23 PS Asphalt contractor milling surface of existing asphalt at parking lot and preparing for surface tomorrow. Potholes and damaged areas of existing surface removed for new base. 11-9-23 PS Contractor spreading and rolling surface asphalt. Contractor expects to complete half of parking lot on west side today and other half tomorrow for business operations. Surface temp 62 degrees and air temp 51 degrees and climbing at time of inspection 11-10-23 PS Contractor spreading and rolling surface asphalt on east side of seam for parking lot surface completetion. Temps acceptable.
Fire Line - Hydrostatic Test Passed 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
12/12/2023
12-12-23 PS Contractor performing hydrostatic test on fireline, test started 10:30 AM 12-12-23 PS Hydrostatic test completed at 12:30 PM, hydro test passed
Underground Electrical Inspection - Commercial Passed 11/16/2023 12/12/2023 12/12/2023
Gas Service Inspection - Commercial Passed 12/15/2023 12/15/2023 12/15/2023
Erosion Control Inspection Partial 12/18/2023 12/18/2023 12/18/2023
Misc
Corrective Action Required
12/04/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 12/20/2023 12/20/2023 12/20/2023
Misc
Corrective Action Required
12/18/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection
Water Service Inspection Passed 12/22/2023 12/22/2023 12/22/2023
Water Line - Construction Inspection Passed 12/22/2023 12/22/2023 12/22/2023
Misc
Informational
12/12/2023
9-29-23 PS Contractor installed 6" fire line and 1 1/2" pex for domestic water line inside of building and stubbed to exterior side of building. 11-30-23 PS Contractor performed tie in at main for fire line. Installed tee with valve, thrust block poured at tee 12-5-23 PS Contractor excavating for backflow vault 12-6-23 PS Contractor set backflow vault, excavating for fire lines to vault. PM Contractor setting backflow in vault 12-7-23 PS Contractor set backflow at vault, water line ran from backflow to interior stub and tee has been installed for hydrant after backflow. PM contractor installing line from tee on south side of backflow towards where hydrant will be placed. Thrust block poured at tee, vault ductile penetrations have been grouted 12-8-23 PS Contractor backfilled areas from prior inspections, private hydrant has been set with thrust block, thrust block poured at ductile at north side line entrance to vault. PM Contractor backfilled remainder of line at hydrant and backfilled at vault 12-12-23 PS Contractor completed line flush of fire line from main to riser. Contractor also flushed fire line at private hydrant
Erosion Control Inspection Partial 1/2/2024 1/2/2024 01/02/2024
Misc
Corrective Action Required
12/20/2023
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection
Electrical Service Inspection Passed 1/4/2024 1/4/2024 01/04/2024
Electrical Service Inspection Failed 12/12/2023 12/12/2023 01/10/2024
Erosion Control Inspection Partial 1/11/2024 1/11/2024 01/11/2024
Misc
Corrective Action Required
01/02/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 1/17/2024 1/17/2024 01/17/2024
Misc
Corrective Action Required
01/11/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection
Above Ceiling Inspection Failed 1/24/2024 1/24/2024 01/24/2024
Misc
Corrective Action Required
01/24/2024
-Support all LV cables from grid -Remove temp lighting from above ceiling
Erosion Control Inspection Partial 1/24/2024 1/24/2024 01/24/2024
Misc
Corrective Action Required
01/17/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection
Above Ceiling Inspection Passed 1/25/2024 1/25/2024 01/25/2024
Misc
Resolved
01/25/2024
-Support all LV cables from grid -Remove temp lighting from above ceiling
Erosion Control Inspection Partial 1/29/2024 1/29/2024 01/29/2024
Misc
Corrective Action Required
01/24/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 2/2/2024 2/2/2024 02/02/2024
Misc
Corrective Action Required
01/29/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection
Grading/Excavation/Fill Inspection Partial 2/5/2024 2/5/2024 02/05/2024
Misc
Informational
06/30/2023
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site 6-23-23 PS Contractor grading at site for building pad 6-26-23 PS Contractor grading at site for building pad 6-30-23 PS Crew preparing site for building footing 2-5-24 PS Contractor grading at front of building
Erosion Control Inspection Partial 2/7/2024 2/7/2024 02/07/2024
Misc
Corrective Action Required
02/02/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 2/9/2024 2/9/2024 02/09/2024
Misc
Corrective Action Required
02/07/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 2/20/2024 2/20/2024 02/20/2024
Misc
Corrective Action Required
02/09/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection 2-20-24 PS Erosion control acceptable at time of inspection
Water Line - Hydrostatic Test Passed 2/20/2024 2/20/2024 02/20/2024
Pavement-Curb Construction Passed 2/20/2024 2/20/2024 02/20/2024
Misc
Informational
11/06/2023
11-3-23 PS Contractor poured curbs at new parking lot stalls NW side. PM contractor completed pour this afternoon and was brushing finish at reinspection 11-6-23 PS Contractor completed new curb construction on east side of building
Alarm Test Passed 2/27/2024 02/27/2024
Sprinkler - Hydrostatic Test Passed 2/27/2024 02/27/2024
Sprinkler - Flow Test Passed 2/27/2024 02/27/2024
Sidewalk Inspection Passed 2/29/2024 2/29/2024 02/29/2024
Misc
Informational
11/21/2023
11-9-23 PS Performed private sidewalk pre pour inspection. Sidewalk is on NE side of building in front of new parking lot stalls. Forms in place and aggregate compacted. OK to pour 11-21-23 PS Contractor pouring private sidewalk at front east side of building
Occupancy Inspection - Engineering Temporary C of O 3/5/2024 3/5/2024 03/05/2024
Misc
Corrective Action Required
03/05/2024
- Provide vegetation, min 70% vegetation growth required - Set all water valve boxes to grade - Provide splash blocks or extensions at roof drain downspouts, min 36" discharge off foundations and walls -clean any remaining construction trash/debris from site OK for 30 day TCO, 4/5/24
Occupancy Inspection - Codes Commercial Ready for Temp CO 3/5/2024 3/5/2024 03/05/2024
Misc
Corrective Action Required
03/05/2024
-Approval required from; Fire, Field Engineer Inspection, Water, Planning -Provide full knee protection under front men restroom sink -Bond copper water line system inside building as required per NEC 250.104 -Install EM light in large men restroom **TCO approved for 30 days
Occupancy Inspection - Planning Temporary C of O 3/5/2024 3/5/2024 03/05/2024
Corrective Action Required
03/05/2024
The total number of parking stalls per the plan is 75. As such the site is required to provide 3 ADA stalls. Per the Civil site plan, 2 ADA stalls are to be located near the front office entrance and 1 ADA stall is to be located in the rear set of parking stalls at the back of the site. At the time of inspection only 1 of the ADA parking stalls was installed near the front office. Please provide an additional ADA parking stall shown on the approved site plans.
Corrective Action Required
03/05/2024
At the time of inspection, the landscaping and ground cover was not installed. Please install the ground cover and landscaping per the approved landscaping plan.
Occupancy Inspection - Fire Temporary C of O 3/5/2024 3/5/2024 03/05/2024
Site Visit Partial 3/12/2024 3/12/2024 03/12/2024
Misc
Informational
11/27/2023
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
11/27/2023
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped. 11-14-23 PS Crews working on building interior. No work for development 11-27-23 PS Met with plumbing contractor to distribute notices for water shutdown for tie in on 11/30 12-27-23 Dustin A, no work for us today 12-28-23 Dustin A, No Activity for our dept . 12-29-23 Dustin A, No activity today for our department. 3-12-24 PS Met w/ Andrew with Rose to look at area of pavement next building B subgrade where existing asphalt surface was removed to pour concrete against building for parts storage
Site Visit Partial 3/14/2024 3/14/2024 03/14/2024
Misc
Informational
03/12/2024
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/12/2024
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped. 11-14-23 PS Crews working on building interior. No work for development 11-27-23 PS Met with plumbing contractor to distribute notices for water shutdown for tie in on 11/30 12-27-23 Dustin A, no work for us today 12-28-23 Dustin A, No Activity for our dept . 12-29-23 Dustin A, No activity today for our department. 3-12-24 PS Met w/ Andrew with Rose to look at area of pavement next building B subgrade where existing asphalt surface was removed to pour concrete against building for parts storage 3-14-24 PS Contractor completed pour for concrete building B inspected and covered prior to rain.
Erosion Control Inspection Partial 3/14/2024 3/14/2024 03/14/2024
Misc
Corrective Action Required
02/20/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection 2-20-24 PS Erosion control acceptable at time of inspection 3-14-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 3/26/2024 3/26/2024 03/26/2024
Misc
Corrective Action Required
03/14/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection 2-20-24 PS Erosion control acceptable at time of inspection 3-14-24 PS Erosion control acceptable at time of inspection
Erosion Control Inspection Partial 3/28/2024 3/28/2024 03/28/2024
Misc
Corrective Action Required
03/26/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection 2-20-24 PS Erosion control acceptable at time of inspection 3-14-24 PS Erosion control acceptable at time of inspection
Grading/Excavation/Fill Inspection Passed 3/28/2024 3/28/2024 03/28/2024
Misc
Informational
02/05/2024
6-21-23 PS Crew on site excavating for building pad/footing. Hauling soil from pad off site 6-23-23 PS Contractor grading at site for building pad 6-26-23 PS Contractor grading at site for building pad 6-30-23 PS Crew preparing site for building footing 2-5-24 PS Contractor grading at front of building
Occupancy Inspection - Engineering Passed 4/4/2024 4/4/2024 04/04/2024
Misc
Resolved
04/04/2024
ESC - (Vegetation/Ground Cover) Passed 4/4/2024 4/4/2024 04/04/2024
Misc
Resolved
04/04/2024
6/29/23 PS - Met Andrew with Rose Construction on site. Discussed install and locations of erosion control. Contractor expected to have erosion control installed ASAP.
Site Visit Complete 4/4/2024 4/4/2024 04/04/2024
Misc
Informational
03/14/2024
7-21-22 RH. Met with Rose Design Build for pre con meeting. Both phases of project was discussed and work was planned to start next week. 7-25-22 RH. Work has not started on site yet. 7-27-22 RH. Work has not started on site. 7-29-22 RH. Erosion control is being placed on site today. Grading should start on 8-1-22.
Misc
Informational
03/14/2024
Met with contractor on site. They were grading for the building pad. Also spoke with them about neighboring property having drainage/erosion concerns. 8/2/22 ES Working on building pad and hauling out excess dirt from site. 8/3/22 ES 8-4-22 RH. Contractor was just pumping water out of building pad. No work being done on site today. 8-5-22 RH. No one working on site in AM. 8-8-22 RH. No work for development in AM. 8-9-22 RH. Contractor was placing lime screenings for building bad. No work for development. 8-10-22 RH. No work for development today. 8-11-22 RH. No work for development today. 8-12-22 RH. No work for development today. Contractor continues to work on building pad. 8-15-22 RH. No work for development today. Building pad is all installed. 8-16-22 RH. No work for development today. Rain has shut down other work on site as well. 8-17-22 RH. No work for development today. 8-18-22 RH. No work for development today. 8-19-22 RH. No work for development today. 8-22-22 RH. Footings were being marked out but no work for development today. 8-23-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-29-22 RH. No work for development since 8-24-22. 8-31-22 RH. No work for development since 8-29-22. 9-6-22 RH. No work for development since 8-31-22. 9-9-22 RH. No work for development since 9-6-22. 9-12-22 RH. No work for development since 9-9-22. 9-26-22 RH. No work for development since 9-12-22. 10-7-22 RH. Contractor has dug out the hole for the septic holding tank and the tank was placed in the ground on a bedding of aggregate. 10-8-22 RH. Contractor buried the septic tank. 10-25-22. No work for development since 10-8-22. 11-7-22 RH. No work for development since 10-25-22. Parking lot remodel will start soon. 11-14-22 RH. No work for development today. 2-13-23 PS Work has not begun for demo of existing building. No new construction on site 3-17-23 PS No work for development, construction has not begun on next phase of project 4-11-23 PS No work for development, construction has not begun on next phase of project 5-15-23 PS Site being prepared for demo of building A. Demo expected to begin May 22nd 5-19-23 PS Equiment mobilized on site. Site prepped for demo of existing building A expected to begin next week. 5-24-23 PS Crews on site demolishing existing building 5-25-23 PS Crews removing material from demo building from site 5-26-23 PS Crews removing demolished building materials from site 5-30-23 PS Crews excavating existing building footing/foundation and removing from site 5-31-23 PS No work on site today due to weather 6-1-23 PS Crews continuing to remove existing building materials from site 6-2-23 PS Crew removing last of existing building material from site and grading soil where existing building was. 6-5-23 PS Existing building demo complete. Site work and construction for new building TBD 6-6-23 PS Crew removing signage from old building 6-7-23 PS Crew on site removing base from signage at old building 6-14-23 PS No additional wok on site today. Building demo is complete with removal of old signage. Contractor ready to begin next phase 7-3-23 PS No work on site for development today 7-11-23 PS Crew on site working on building footing/pad 7-12-23 PS Crew on site pouring building footing 7-13-23 PS Crew working on building footing 7-17-23 PS Crew working on building footing 7-27-23 PS No activity on site 8-2-23 PS No activity on site 8-4-23 PS No activity on site 8-7-23 PS No activity on site 8-9-23 PS No activity on site 8-10-23 PS No activity on site 8-11-23 PS No activity on site 8-14-23 PS No activity on site 8-15-23 PS No activity on site 8-16-23 PS No activity on site 8-17-23 PS No activity on site 8-21-23 PS No work for development today 8-22-23 PS No work for development today 8-24-23 PS No work for development today 8-25-23 PS No work for development today 8-31-23 PS Contractor on site installing pre fab wall panels 9-6-23 PS Contractor setting tilt up walls 9-8-23 PS Contractor setting tilt up walls 9-11-23 PS Contractor setting tilt up walls 9-12-23 PS Contractor setting tilt up walls 9-14-23 PS Contractor setting tile up walls 9-15-23 PS Crew working on building shell 9-20-23 PS Spoke with GC, work expected to begin either late this week or early next week on exterior utilities (fire, water, sanitary) 10-5-23 PS No work for development 10-12-23 PS No work for development 10-16-23 PS Contractor pouring building interior slab 10-17-23 PS Contractor pouring building interior slab 10-31-23 PS Contractor backfilling plumbing, no additional work for development today 11-7-23 PS Met with Andrew with Rose Construction and plumbing contractor on site to discuss requirements for upcoming water tie in 11-13-23 PS Crews working on interior of building. New parking lot being striped. 11-14-23 PS Crews working on building interior. No work for development 11-27-23 PS Met with plumbing contractor to distribute notices for water shutdown for tie in on 11/30 12-27-23 Dustin A, no work for us today 12-28-23 Dustin A, No Activity for our dept . 12-29-23 Dustin A, No activity today for our department. 3-12-24 PS Met w/ Andrew with Rose to look at area of pavement next building B subgrade where existing asphalt surface was removed to pour concrete against building for parts storage 3-14-24 PS Contractor completed pour for concrete building B inspected and covered prior to rain.
Erosion Control Inspection Passed 4/4/2024 4/4/2024 04/04/2024
Misc
Corrective Action Required
03/28/2024
6-28-23 PS Install all erosion control methods per approved plans on site 7-13-23 PS Erosion control installed and acceptable at time of inspection 7-17-23 PS Erosion control within compliance at time of inspection 7-21-23 PS Erosion control acceptable at time of inspection 7-24-23 PS Erosion control acceptable at time of inspection 7-31-23 PS Erosion control acceptable at time of inspection 8-1-23 PS Erosion control acceptable at time of inspection 8-3-23 PS Erosion control acceptable at time of inspection 8-7-23 PS Erosion control acceptable at time of inspection 8-9-23 PS Erosion control acceptable at time of inspection 8-11-23 PS Erosion control acceptable at time of inspection 8-14-23 PS Erosion control acceptable at time of inspection 8-16-23 PS Erosion control acceptable at time of inspection 8-21-23 PS Erosion control acceptable at time of inspection 8-30-23 PS Erosion control acceptable at time of inspection 9-6-23 PS Erosion control acceptable at time of inspection 9-11-23 PS Erosion control acceptable at time of inspection 9-20-23 PS Erosion control acceptable at time of inspection 9-25-23 PS Erosion control acceptable at time of inspection 10-2-23 PS Erosion control acceptable at time of inspection 10-11-23 PS Erosion control acceptable at time of inspection 10-24-23 PS Erosion control acceptable at time of inspection 10-27-23 PS Erosion control acceptable at time of inspection 11-21-23 PS Erosion control acceptable at time of inspection 11-27-23 PS Erosion control acceptable at time of inspection 12-4-23 PS Erosion control acceptable at time of inspection 12-18-23 PS Erosion control acceptable at time of inspection 12-20-23 PS Erosion control acceptable at time of inspection 1-2-24 PS Erosion control acceptable at time of inspection 1-11-24 PS Erosion control acceptable at time of inspection 1-17-24 PS Erosion control acceptable at time of inspection 1-24-24 PS Erosion control acceptable at time of inspection 1-29-24 PS Erosion control acceptable at time of inspection 2-2-24 PS Erosion control acceptable at time of inspection 2-7-24 PS Erosion control acceptable at time of inspection 2-9-24 PS Erosion control acceptable at time of inspection 2-20-24 PS Erosion control acceptable at time of inspection 3-14-24 PS Erosion control acceptable at time of inspection
Occupancy Inspection - Fire Passed 4/5/2024 4/5/2024 04/04/2024
Occupancy Inspection - Planning Passed 4/5/2024 4/5/2024 04/05/2024
Occupancy Inspection - Codes Commercial Full C of O 4/5/2024 4/5/2024 04/05/2024
Misc
Resolved
04/05/2024
Documents & Images
Date Uploaded File Type Document Name
10/22/2021 Application Form Commercial Permit Application Crash Champions 10-22-21
10/22/2021 Application Form Excise Tax Application
10/22/2021 Engineer Report/Study Crash Champions_Struct Calcs BDC_10-22-21
10/22/2021 Plans Crash Champions - Lees Summit - Permit - Bid Set
10/25/2021 Letter Fire Building Plan Review
10/26/2021 Letter DS P/R Corrections Document
12/06/2021 Letter PL2021414 City comment response letter
12/06/2021 Plans Crash Champions - Lees Summit - Permit - Bid Set
12/06/2021 Letter building codes review letter response letter
12/07/2021 Letter Fire Building Plan Review
06/28/2022 Approved Plans Approved Crash Champions FDP
07/21/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter License Tax Bill
07/25/2022 Letter INSPECTION SUMMARY
07/28/2022 Letter INSPECTION SUMMARY
07/29/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/09/2022 Letter INSPECTION SUMMARY
08/10/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/12/2022 Letter INSPECTION SUMMARY
08/15/2022 Letter INSPECTION SUMMARY
08/15/2022 Letter INSPECTION SUMMARY
08/16/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/18/2022 Letter INSPECTION SUMMARY
08/19/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/24/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/05/2022 Plans Crash Champions - Lees Summit - Permit - Bid Set
10/05/2022 Approved Plans approved - Crash Champions - Lees Summit - Permit - Bid Set1
10/07/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/24/2022 Letter INSPECTION SUMMARY
10/24/2022 Letter INSPECTION SUMMARY
10/25/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/10/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY
11/21/2022 Letter INSPECTION SUMMARY

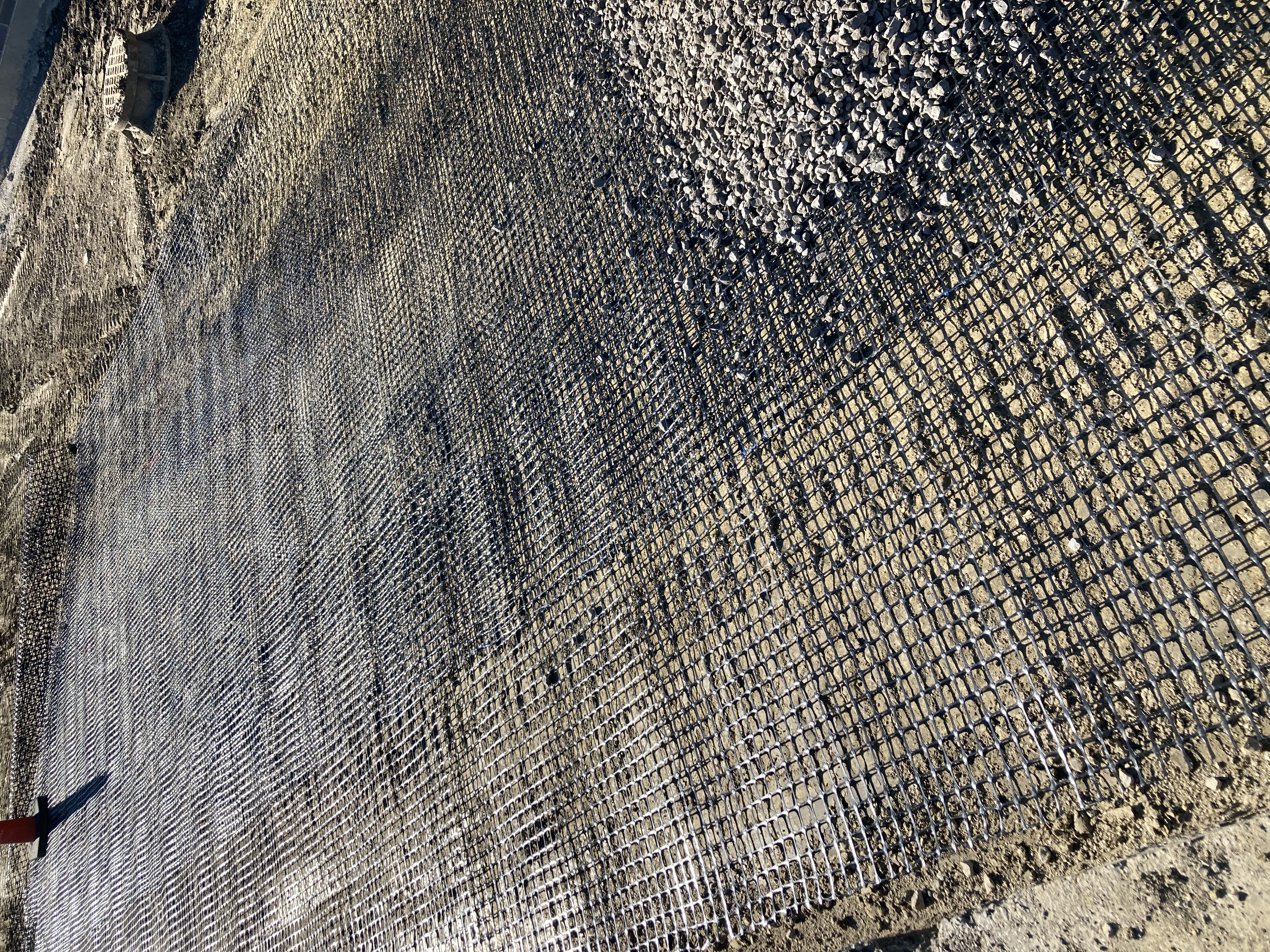

11/21/2022 Permit 11-21-22 Geogrid placement
11/21/2022 Approved Plans APPROVED REVISED C5 DETAILS - PRIVATE - PAVE 1
11/22/2022 Letter INSPECTION SUMMARY
11/23/2022 Letter INSPECTION SUMMARY
11/23/2022 Letter INSPECTION SUMMARY
11/28/2022 Letter INSPECTION SUMMARY
11/28/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/08/2022 Letter INSPECTION SUMMARY
02/02/2023 Receipt Receipt for transaction: 2023-000649
02/02/2023 Letter DS Building Permit
02/13/2023 Letter INSPECTION SUMMARY
03/17/2023 Letter INSPECTION SUMMARY
03/22/2023 Letter INSPECTION SUMMARY
03/23/2023 Letter INSPECTION SUMMARY
03/31/2023 Letter INSPECTION SUMMARY
04/11/2023 Letter INSPECTION SUMMARY
05/15/2023 Letter INSPECTION SUMMARY
05/19/2023 Letter INSPECTION SUMMARY
05/23/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter INSPECTION SUMMARY
05/25/2023 Letter INSPECTION SUMMARY
05/26/2023 Letter INSPECTION SUMMARY
05/30/2023 Letter INSPECTION SUMMARY
05/31/2023 Letter INSPECTION SUMMARY
06/01/2023 Letter INSPECTION SUMMARY
06/02/2023 Letter INSPECTION SUMMARY
06/05/2023 Letter INSPECTION SUMMARY
06/06/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/14/2023 Letter INSPECTION SUMMARY
06/19/2023 Letter INSPECTION SUMMARY
06/21/2023 Letter INSPECTION SUMMARY
06/22/2023 Letter INSPECTION SUMMARY
06/23/2023 Letter INSPECTION SUMMARY
06/26/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
06/29/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter INSPECTION SUMMARY
07/03/2023 Letter INSPECTION SUMMARY
07/06/2023 Letter INSPECTION SUMMARY
07/10/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/12/2023 Letter INSPECTION SUMMARY
07/13/2023 Letter INSPECTION SUMMARY
07/14/2023 Letter INSPECTION SUMMARY
07/17/2023 Letter INSPECTION SUMMARY
07/17/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/19/2023 Letter INSPECTION SUMMARY
07/21/2023 Letter INSPECTION SUMMARY
07/24/2023 Letter INSPECTION SUMMARY
07/25/2023 Letter INSPECTION SUMMARY
07/27/2023 Letter INSPECTION SUMMARY
07/31/2023 Letter INSPECTION SUMMARY
08/01/2023 Letter INSPECTION SUMMARY
08/02/2023 Letter INSPECTION SUMMARY
08/03/2023 Letter INSPECTION SUMMARY
08/04/2023 Letter INSPECTION SUMMARY
08/07/2023 Letter INSPECTION SUMMARY
08/07/2023 Letter INSPECTION SUMMARY
08/09/2023 Letter INSPECTION SUMMARY
08/09/2023 Letter INSPECTION SUMMARY
08/10/2023 Letter INSPECTION SUMMARY
08/11/2023 Letter INSPECTION SUMMARY
08/11/2023 Letter INSPECTION SUMMARY
08/14/2023 Letter INSPECTION SUMMARY
08/14/2023 Letter INSPECTION SUMMARY
08/15/2023 Letter INSPECTION SUMMARY
08/16/2023 Letter INSPECTION SUMMARY
08/16/2023 Letter INSPECTION SUMMARY
08/18/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/22/2023 Letter INSPECTION SUMMARY
08/24/2023 Letter INSPECTION SUMMARY
08/25/2023 Letter INSPECTION SUMMARY
08/30/2023 Letter INSPECTION SUMMARY
08/31/2023 Letter INSPECTION SUMMARY
09/06/2023 Letter INSPECTION SUMMARY
09/06/2023 Letter INSPECTION SUMMARY
09/08/2023 Letter INSPECTION SUMMARY
09/11/2023 Letter INSPECTION SUMMARY
09/11/2023 Letter INSPECTION SUMMARY
09/13/2023 Letter INSPECTION SUMMARY
09/14/2023 Letter INSPECTION SUMMARY
09/15/2023 Letter INSPECTION SUMMARY
09/20/2023 Letter INSPECTION SUMMARY
09/20/2023 Letter INSPECTION SUMMARY
09/20/2023 Letter INSPECTION SUMMARY
09/25/2023 Letter INSPECTION SUMMARY
09/25/2023 Letter INSPECTION SUMMARY
09/29/2023 Letter INSPECTION SUMMARY
10/02/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/05/2023 Letter INSPECTION SUMMARY
10/11/2023 Letter INSPECTION SUMMARY
10/12/2023 Letter INSPECTION SUMMARY
10/16/2023 Letter INSPECTION SUMMARY
10/17/2023 Letter INSPECTION SUMMARY
10/19/2023 Letter INSPECTION SUMMARY
10/20/2023 Letter INSPECTION SUMMARY
10/23/2023 IMG_0079
10/23/2023 Letter INSPECTION SUMMARY
10/23/2023 Letter INSPECTION SUMMARY
10/24/2023 Letter INSPECTION SUMMARY
10/24/2023 C5 DETAILS - PRIVATE - PAVE 1
10/27/2023 Letter INSPECTION SUMMARY
10/30/2023 Letter INSPECTION SUMMARY
10/31/2023 Letter INSPECTION SUMMARY
11/01/2023 Letter INSPECTION SUMMARY
11/02/2023 Letter INSPECTION SUMMARY
11/02/2023 Letter INSPECTION SUMMARY
11/02/2023 Letter INSPECTION SUMMARY
11/02/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/03/2023 Letter INSPECTION SUMMARY
11/06/2023 Letter INSPECTION SUMMARY
11/07/2023 Letter INSPECTION SUMMARY
11/08/2023 Crash Champions-FP1
11/08/2023 Crash Champions Calculation Area #1
11/08/2023 Letter INSPECTION SUMMARY
11/09/2023 Letter INSPECTION SUMMARY
11/09/2023 Letter INSPECTION SUMMARY
11/10/2023 Letter INSPECTION SUMMARY
11/13/2023 Letter INSPECTION SUMMARY
11/14/2023 Letter INSPECTION SUMMARY
11/21/2023 Letter INSPECTION SUMMARY
11/21/2023 Letter INSPECTION SUMMARY
11/27/2023 Letter Fire (Sprinkler) Plan Review
11/27/2023 Letter INSPECTION SUMMARY
11/27/2023 Letter INSPECTION SUMMARY
11/30/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/05/2023 Letter INSPECTION SUMMARY
12/06/2023 Letter INSPECTION SUMMARY
12/06/2023 Letter INSPECTION SUMMARY
12/06/2023 Letter INSPECTION SUMMARY
12/07/2023 Letter INSPECTION SUMMARY
12/06/2023 Letter INSPECTION SUMMARY
12/07/2023 Letter INSPECTION SUMMARY
12/08/2023 Letter INSPECTION SUMMARY
12/08/2023 Letter INSPECTION SUMMARY
12/11/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
12/15/2023 Letter INSPECTION SUMMARY
12/18/2023 Letter INSPECTION SUMMARY
12/20/2023 Letter INSPECTION SUMMARY
12/20/2023 Receipt Receipt for transaction:2023-009238
12/22/2023 Letter INSPECTION SUMMARY
12/22/2023 Letter INSPECTION SUMMARY
01/02/2024 Letter INSPECTION SUMMARY
01/04/2024 Letter INSPECTION SUMMARY
01/11/2024 Letter INSPECTION SUMMARY
01/17/2024 Letter INSPECTION SUMMARY
01/24/2024 Letter INSPECTION SUMMARY
01/24/2024 Letter INSPECTION SUMMARY
01/24/2024 Letter INSPECTION SUMMARY
01/25/2024 Letter INSPECTION SUMMARY
01/26/2024 23-1054L Phase 23-17 Crash Champions - fire alarm Sealed
01/29/2024 Crash Champions 2 - Special Inspections Final Report
01/29/2024 Letter INSPECTION SUMMARY
02/02/2024 Letter INSPECTION SUMMARY
02/05/2024 Letter INSPECTION SUMMARY
02/06/2024 23-1054L Phase 23-17 Crash Champions - fire alarm Sealed APPROVED
02/06/2024 Letter Fire (Alarm) Plan Review Notice
02/07/2024 Letter INSPECTION SUMMARY
02/09/2024 Letter INSPECTION SUMMARY
02/20/2024 Letter INSPECTION SUMMARY
02/20/2024 Letter INSPECTION SUMMARY
02/20/2024 Letter INSPECTION SUMMARY
02/21/2024 Letter Fire (Sprinkler) Plan Review
02/21/2024 23-1054L Phase 23-17 Crash Champions - fire alarm Sealed APPROVED
02/29/2024 Letter INSPECTION SUMMARY
02/29/2024 Letter INSPECTION SUMMARY
03/05/2024 Letter INSPECTION SUMMARY
03/05/2024 Letter INSPECTION SUMMARY
03/06/2024 Certificate/License Codes Temporary Certificate of Occupancy
03/06/2024 Receipt Receipt for transaction:2024-001358
03/12/2024 Letter INSPECTION SUMMARY
03/14/2024 Letter INSPECTION SUMMARY
03/14/2024 Letter INSPECTION SUMMARY
03/26/2024 Letter INSPECTION SUMMARY
03/28/2024 Letter INSPECTION SUMMARY
03/28/2024 Letter INSPECTION SUMMARY
04/04/2024 Letter INSPECTION SUMMARY
04/04/2024 Letter INSPECTION SUMMARY
04/04/2024 Letter INSPECTION SUMMARY
04/05/2024 Letter INSPECTION SUMMARY
04/05/2024 Letter Codes Final Certificate of Occupancy
04/05/2024 Letter Field Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
