Permit Application Status

PRSUBD20201466


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20201466
Public Infrastructure
Final Acceptance
CHAPEL RIDGE RESIDENTIAL LLC
DEVELOPMENT COMPLETE
Full subdivision development.
06/03/2020
07/29/2020
09/16/2024
02/29/2024
Locations
Contacts
KEVIN HIGDON CONSTRUCTION, LLC, Address:P O BOX 847, Phone:(816) 524-9797
CHAPEL RIDGE RESIDENTIAL LLC, Address:3170 NE CARNEGIE DR #400
KEVIN HIGDON CONSTRUCTION, LLC, Address:P O BOX 847, Phone:(816) 524-9797
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/03/2020 06/14/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
Right of Way Permit Fee $80.00 $80.00 Paid 07/27/2020
Sanitary Sewer Insp Fees $3,732.72 $3,732.72 Paid 07/27/2020
Water Insp Fee $2,282.86 $2,282.86 Paid 07/27/2020
Water Test Fee $600.00 $600.00 Paid 07/27/2020
Storm Sewer Inspection Fee $3,384.51 $3,384.51 Paid 07/29/2020
Paved Surface Inspection Fee $6,637.80 $6,637.80 Paid 07/29/2020
Site Grading Fee $2,214.63 $2,214.63 Paid 07/29/2020
Outstanding Fees Amount Paid Owing Date Paid


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water Line - Construction Inspection Partial 07/31/2020
Misc
Informational
07/31/2020

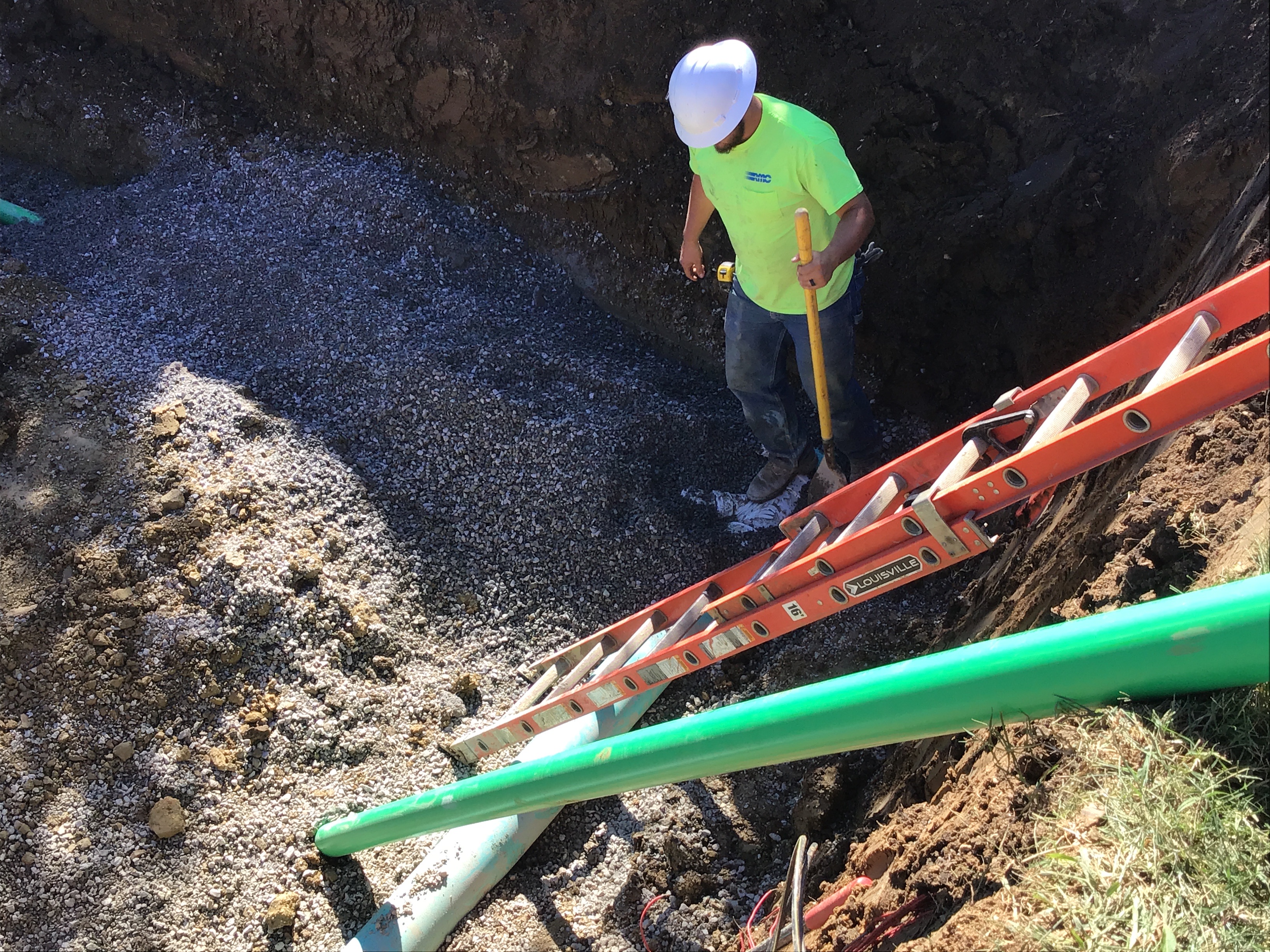

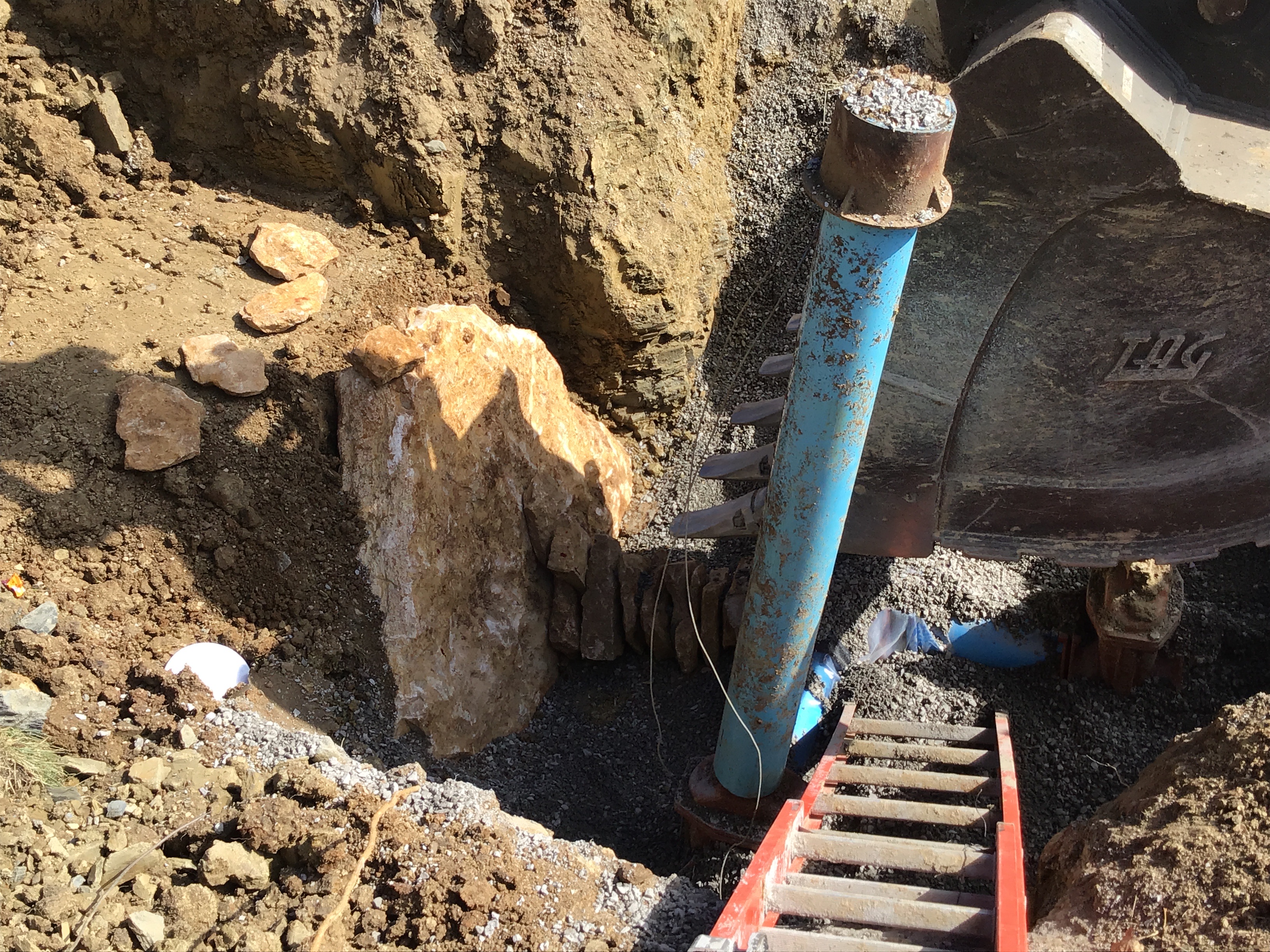

7/31/20 Friday - Contractor began to remove existing water line on Wednesday 7/29/20. Approximately 350’ total was removed from 7/29/20 to 7/31. Contractor will continue to remove water line as per plan on 8/1/20 Saturday, inspection on work performed will be done on 8/3/20 Monday.
Water Line - Construction Inspection Partial 08/03/2020
Misc
Informational
08/03/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Water Line - Construction Inspection Partial 08/04/2020
Misc
Informational
08/03/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
08/04/2020
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.

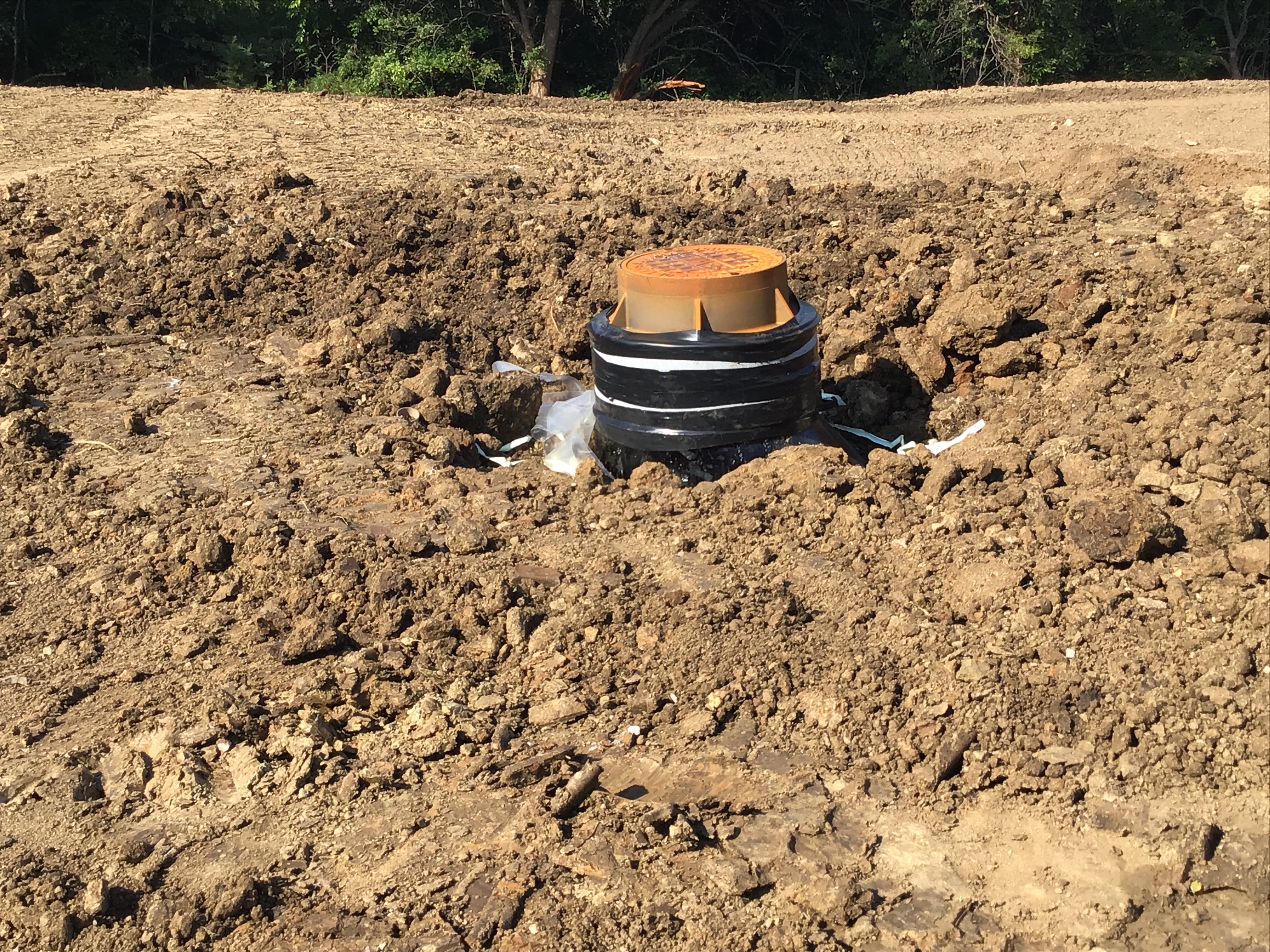

Sanitary Sewer - Manhole Adjustment Partial 08/04/2020
Misc
Informational
08/04/2020
8/4/20 Tuesday see detail sheet c 404 Existing Manhole Wall Connection. Contractor coring into existing manhole using a gasket for new pipe opening. Contractor (Beemer Const.) will installed a plug in gasket until the start to install sanitary line.
Grading/Excavation/Fill Inspection Partial 08/17/2020
Misc
Partial Correction
08/17/2020

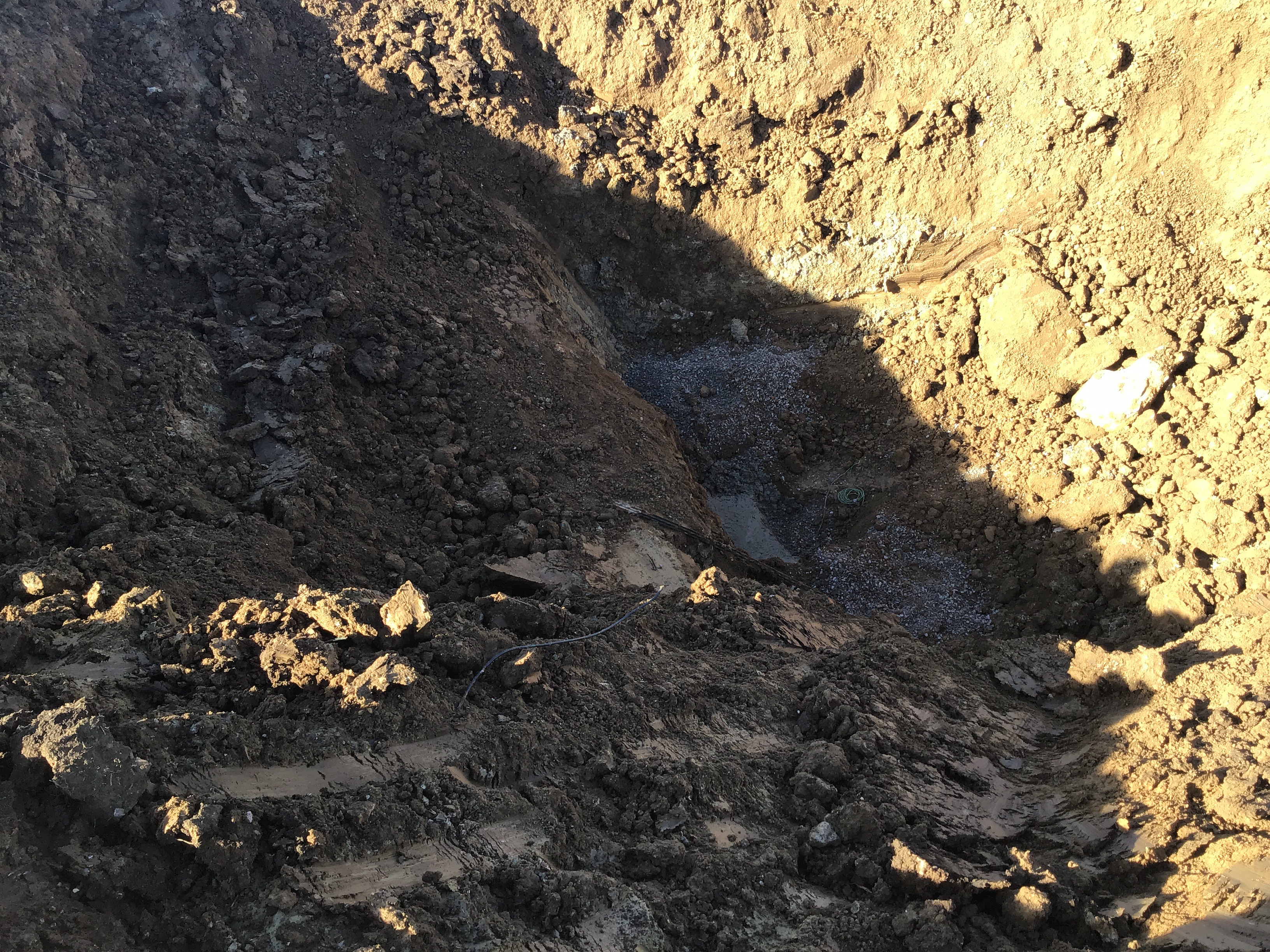

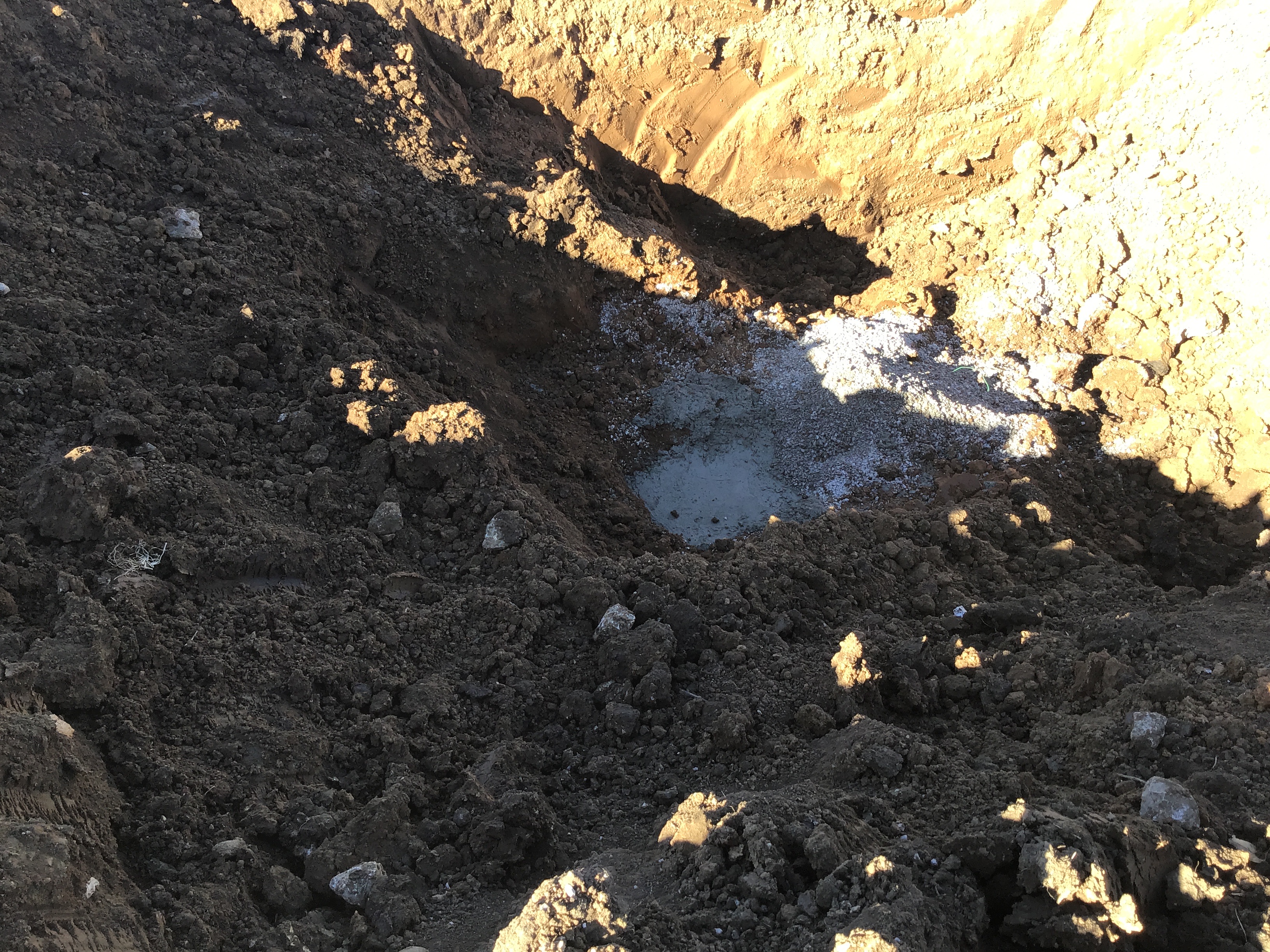

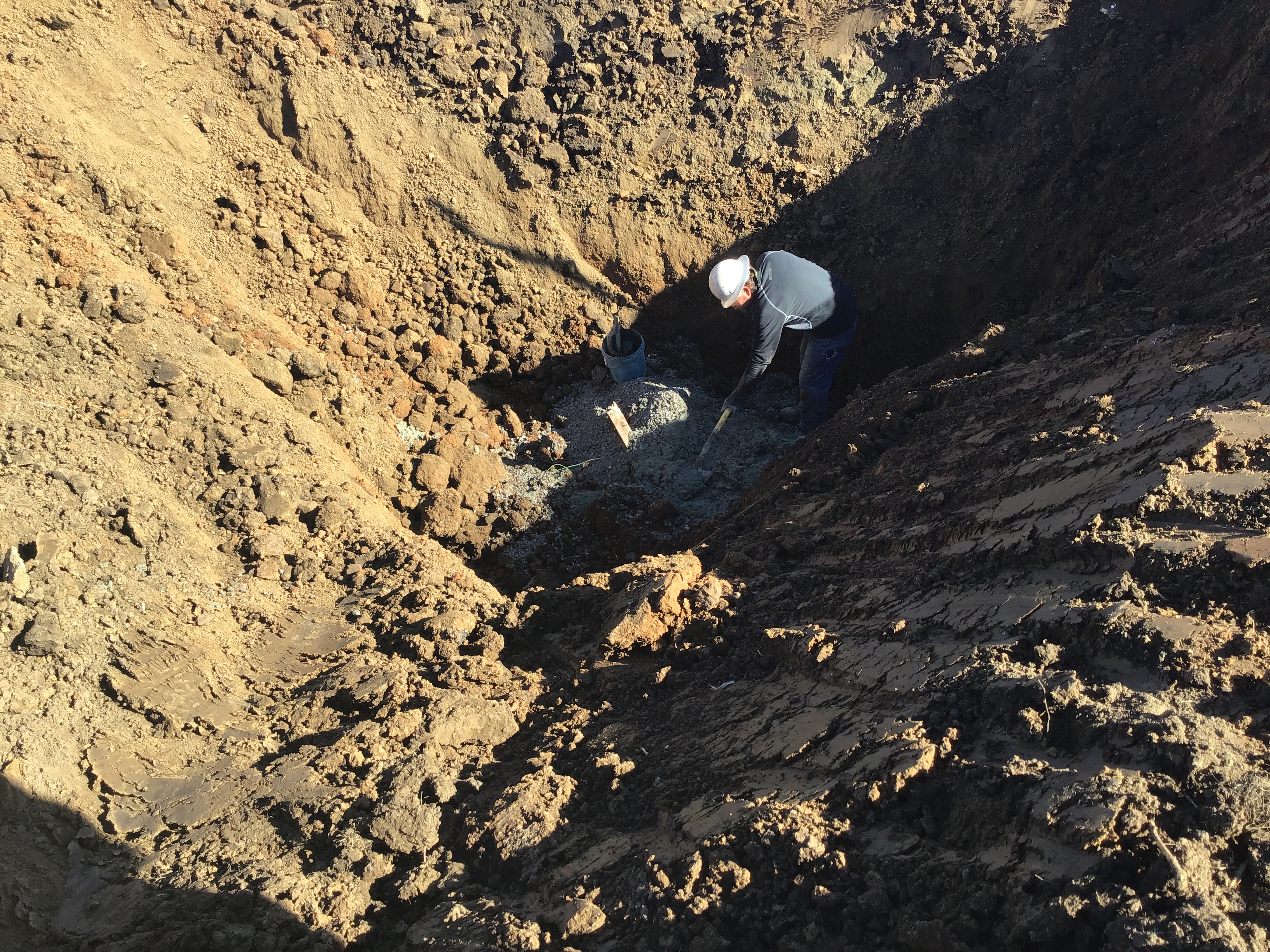

8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Grading/Excavation/Fill Inspection Partial 08/20/2020
Misc
Partial Correction
08/17/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
08/18/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
08/20/2020

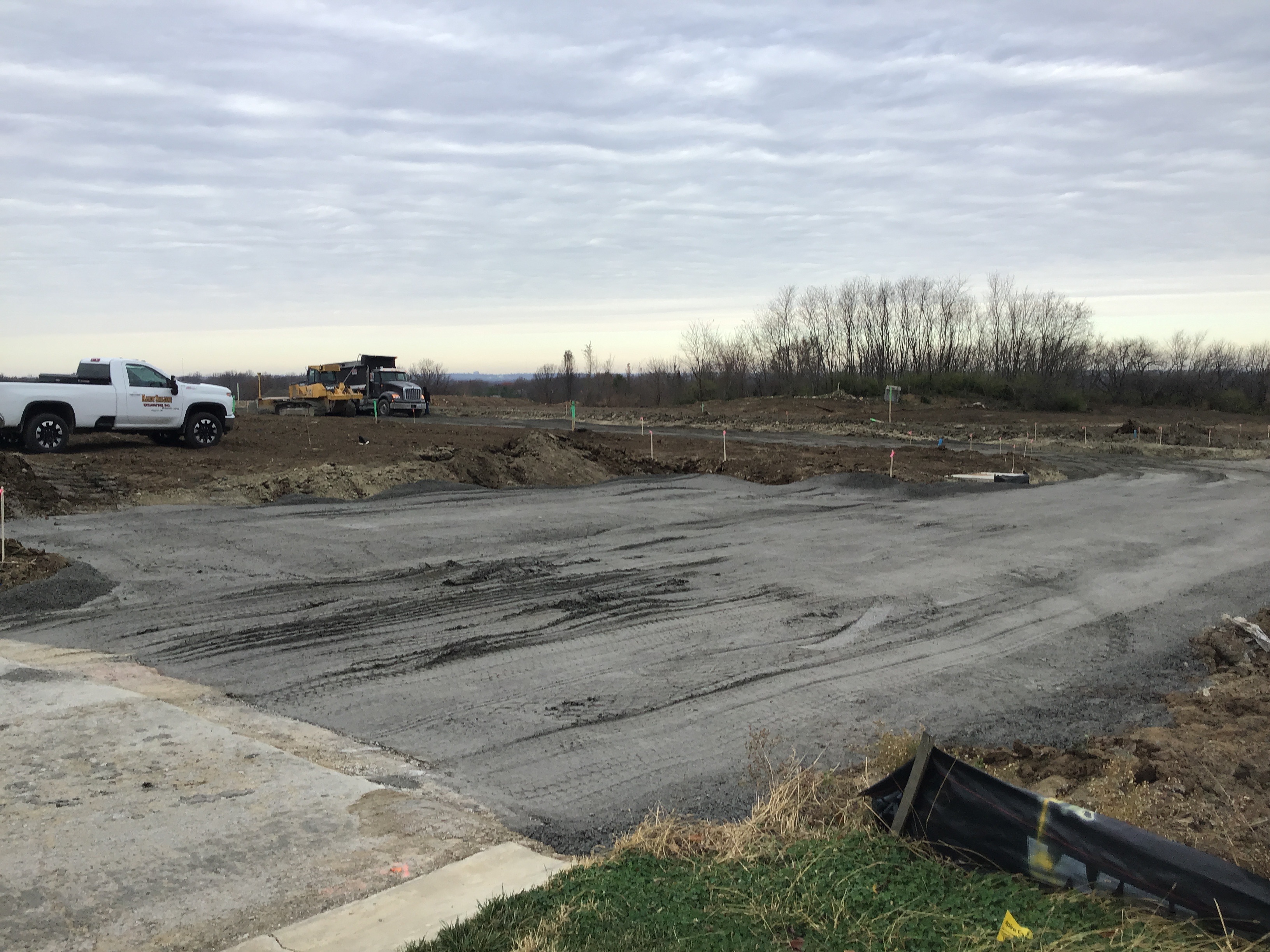

8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Grading/Excavation/Fill Inspection Partial 08/21/2020
Misc
Partial Correction
08/20/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
08/20/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
08/20/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
08/21/2020

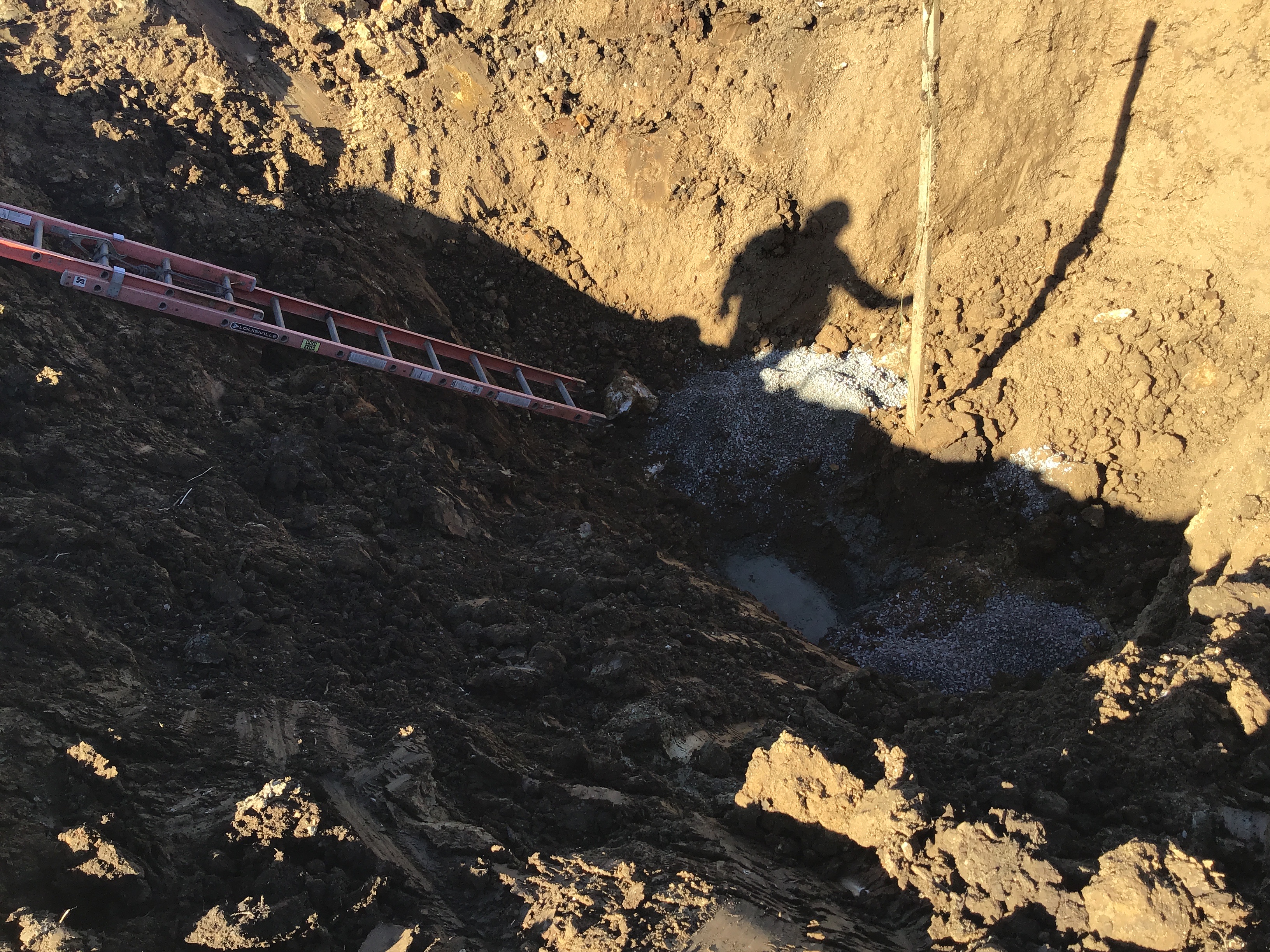

8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Grading/Excavation/Fill Inspection Partial 08/26/2020
Misc
Partial Correction
08/21/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
08/21/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
08/21/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
08/21/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
08/26/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Sanitary - Material Verification Partial 09/03/2020
Misc
Informational
09/03/2020
9/2/20 Thursday Began materials inspection on sanitary piping, manholes, and metal & concrete rings.
Sanitary Sewer Construction Inspection Partial 09/03/2020
Misc
Informational
09/03/2020
9/2/20 Wednesday Cored in existing manhole and laid 4 sticks of pipe approximately 80’ of 8” sanitary pipe. 9/3/20 Thursday Contractor ( Beemer Const. ) continues to lay 8” sanitary pipe. Approximately 190’ of 8” SDR-26 PVC was installed. Sanitary B-1 Manhole was installed and B-2 should finished by the end of day.
Sanitary Sewer Construction Inspection Partial 09/04/2020
Misc
Informational
09/04/2020

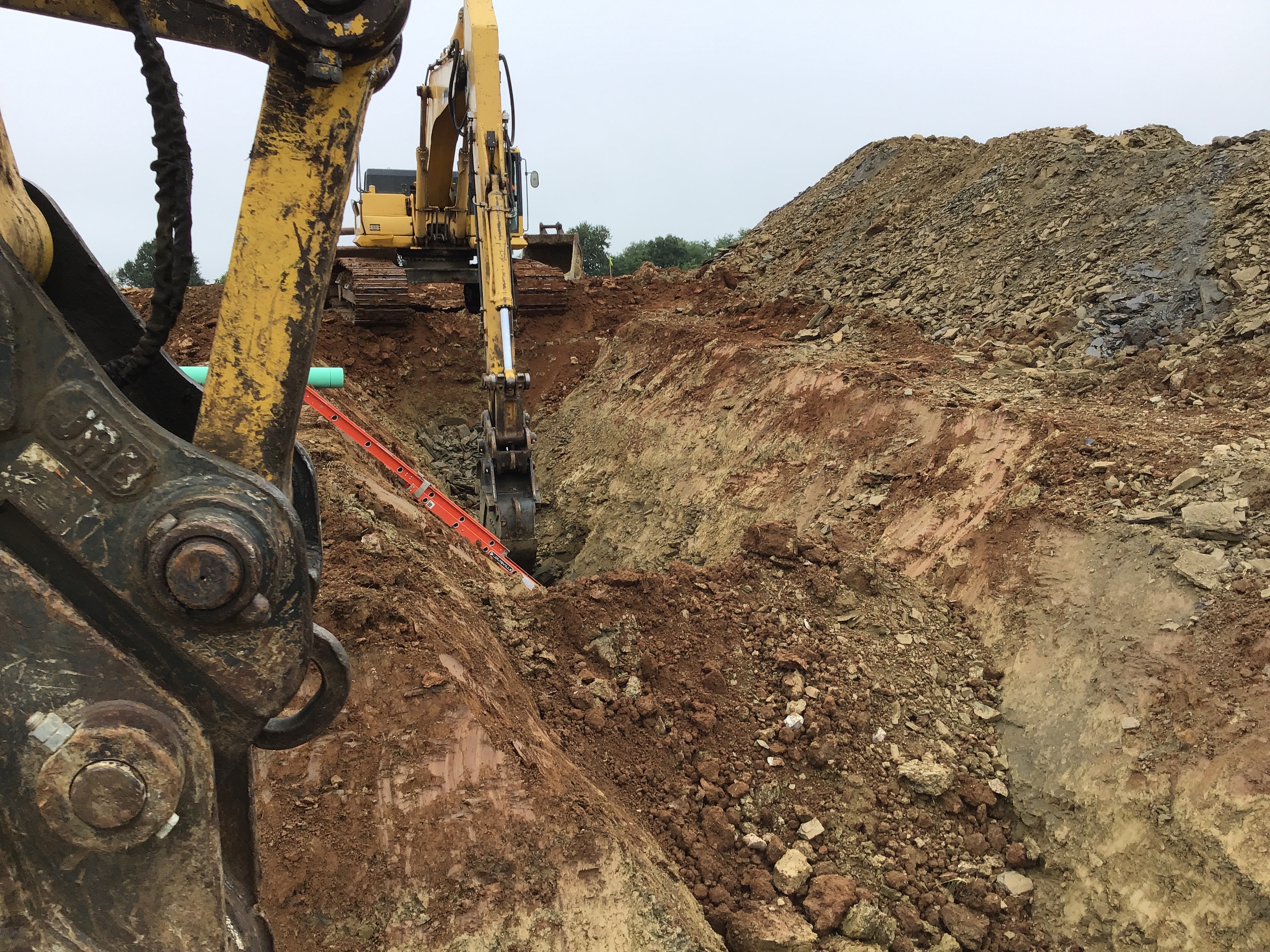

9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Sanitary Sewer Construction Inspection Partial 09/08/2020
Misc
Informational
09/04/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/08/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Sanitary Sewer Construction Inspection Partial 09/09/2020
Misc
Informational
09/08/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/08/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/09/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes. Contractor installed lateral Lot 23 of 8”SDR-26 PVC from Sta 0+00 to 0+60 on Line “A”.
Sanitary Sewer Construction Inspection Partial 09/15/2020
Misc
Informational
09/09/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/09/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/09/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/15/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Sanitary Sewer Construction Inspection Partial 09/16/2020
Misc
Informational
09/15/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/15/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/15/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/15/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/16/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Sanitary Sewer Construction Inspection Partial 09/17/2020
Misc
Informational
09/16/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/16/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/16/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/16/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/16/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/17/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Sanitary Sewer Construction Inspection Partial 09/18/2020
Misc
Informational
09/17/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/17/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/17/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/17/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/17/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/17/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/18/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Sanitary Sewer Construction Inspection Partial 09/21/2020
Misc
Informational
09/18/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/18/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/18/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/18/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/18/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/18/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/18/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/21/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 100’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3. Sanitary MH A-2 was installed.
Sanitary Sewer Construction Inspection Partial 09/21/2020
Misc
Informational
09/21/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/21/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/21/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/21/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/21/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/21/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/21/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/21/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Sanitary Sewer Construction Inspection Partial 09/22/2020
Misc
Informational
09/21/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/21/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/21/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/21/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/21/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/21/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/21/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/21/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/22/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Sanitary Sewer Construction Inspection Partial 09/23/2020
Misc
Informational
09/22/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/22/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/22/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/22/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/22/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/22/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/22/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/22/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/22/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/23/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Sanitary Sewer Construction Inspection Partial 09/24/2020
Misc
Informational
09/23/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/23/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/23/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/23/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/23/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/23/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/23/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/23/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/23/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/23/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
09/24/2020

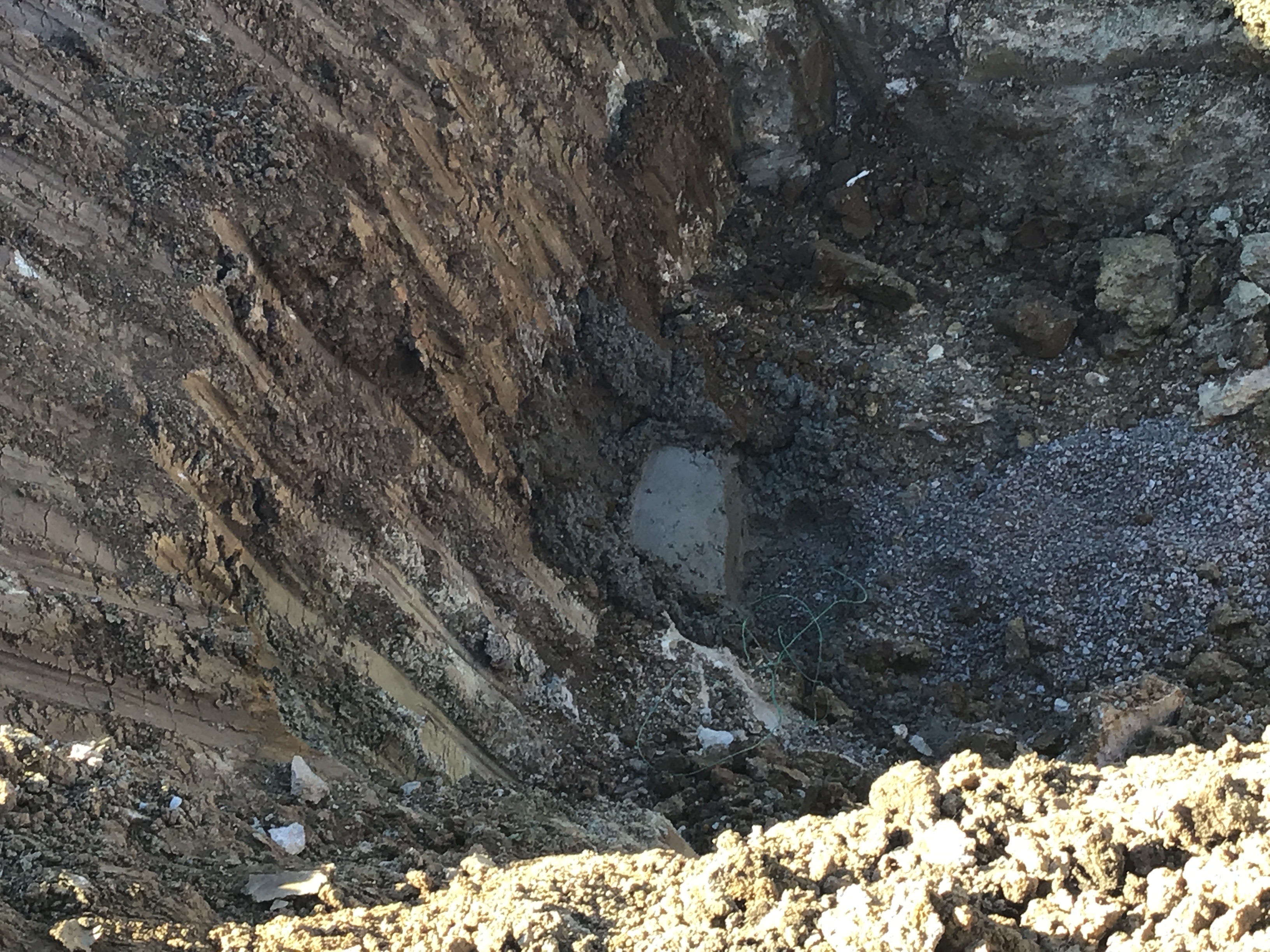

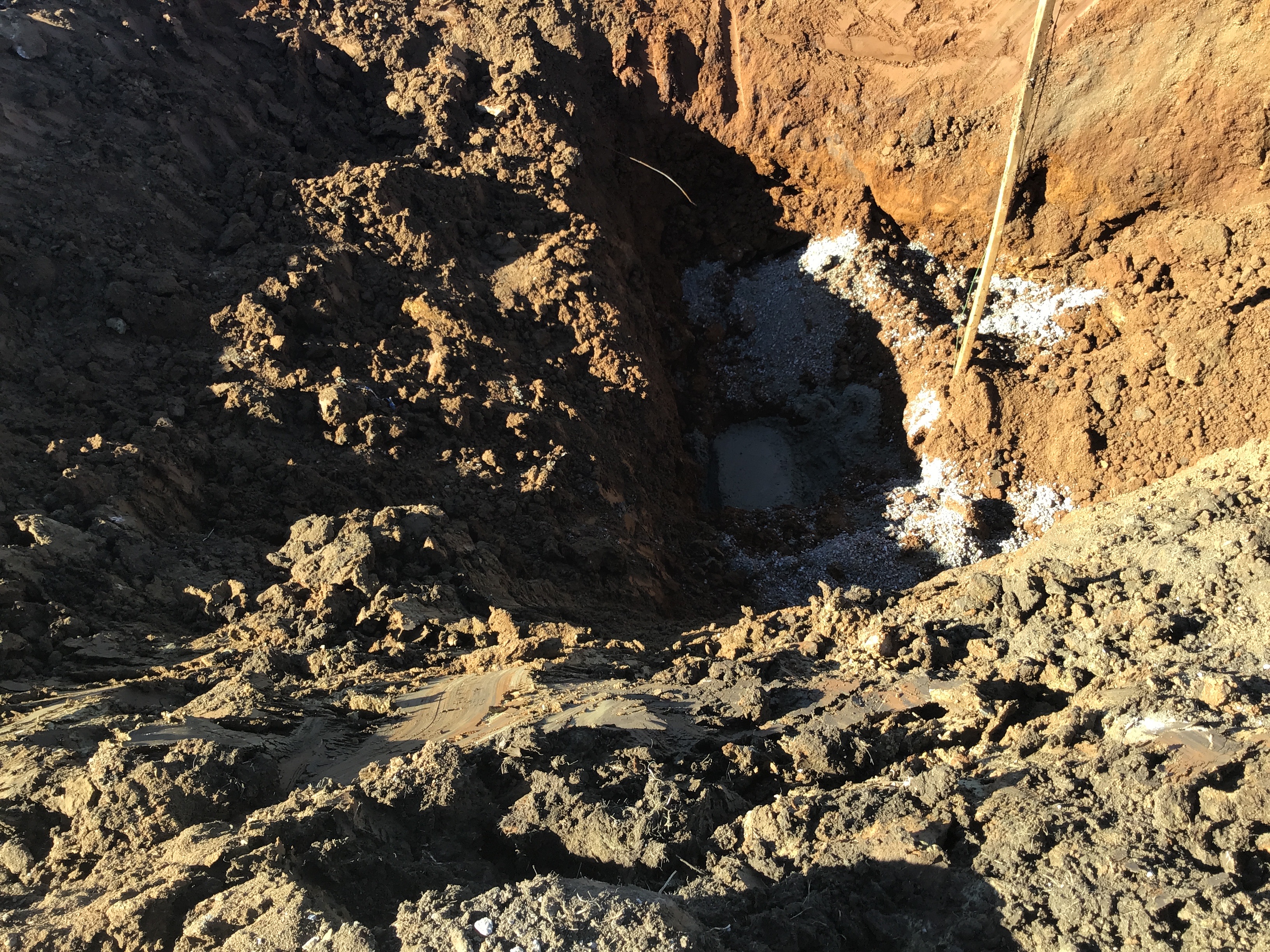

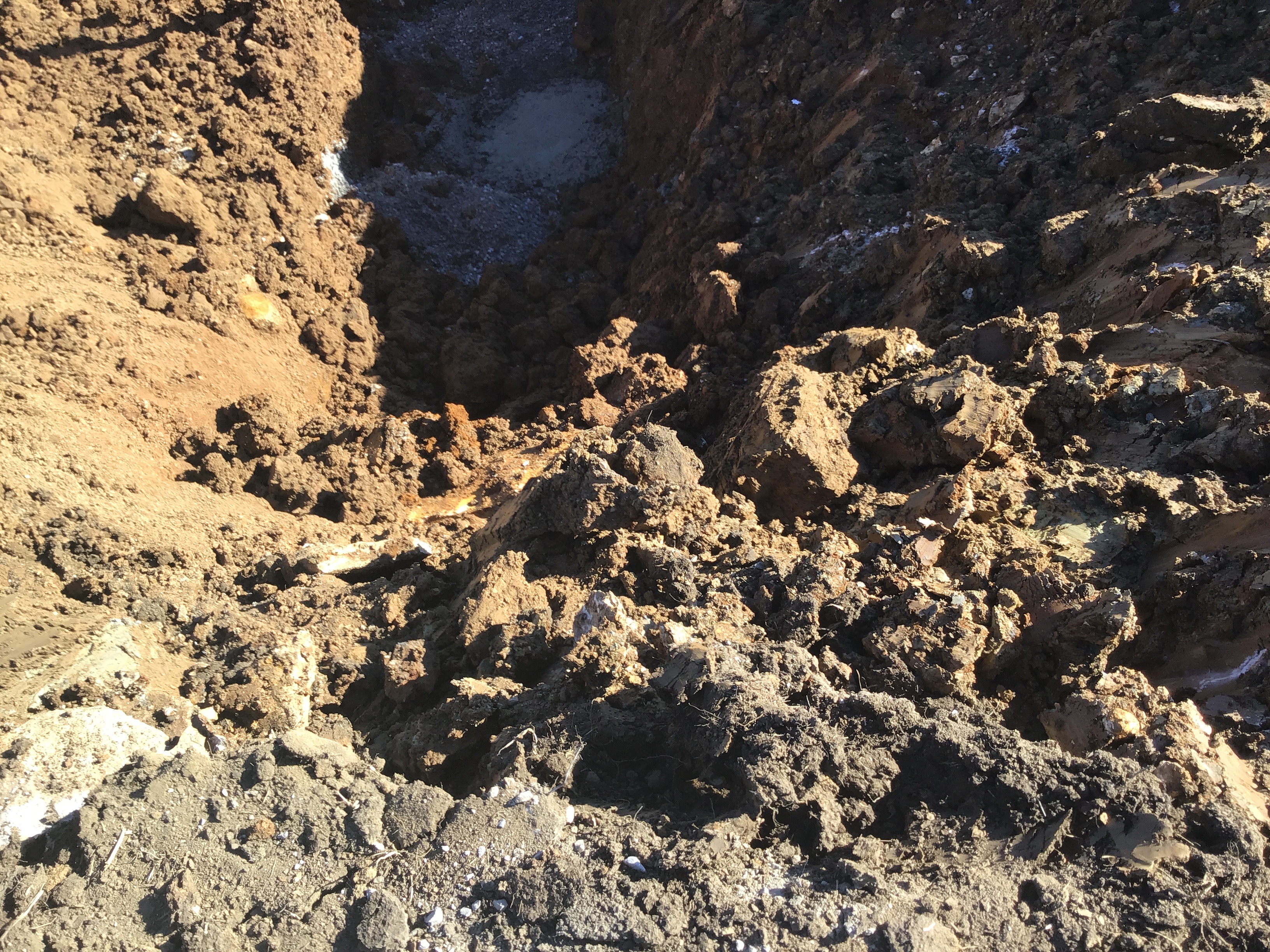

9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock. Approximately 30’ of 8” sanitary pipe was installed. Lateral 1-3 lot 17 was installed. Contractor continue to have issues with their breakers due to the hard rock.
Sanitary Sewer Construction Inspection Partial 09/25/2020
Misc
Informational
09/24/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/24/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/24/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/24/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/24/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/24/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/24/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/24/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/24/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/24/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
09/24/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
09/25/2020

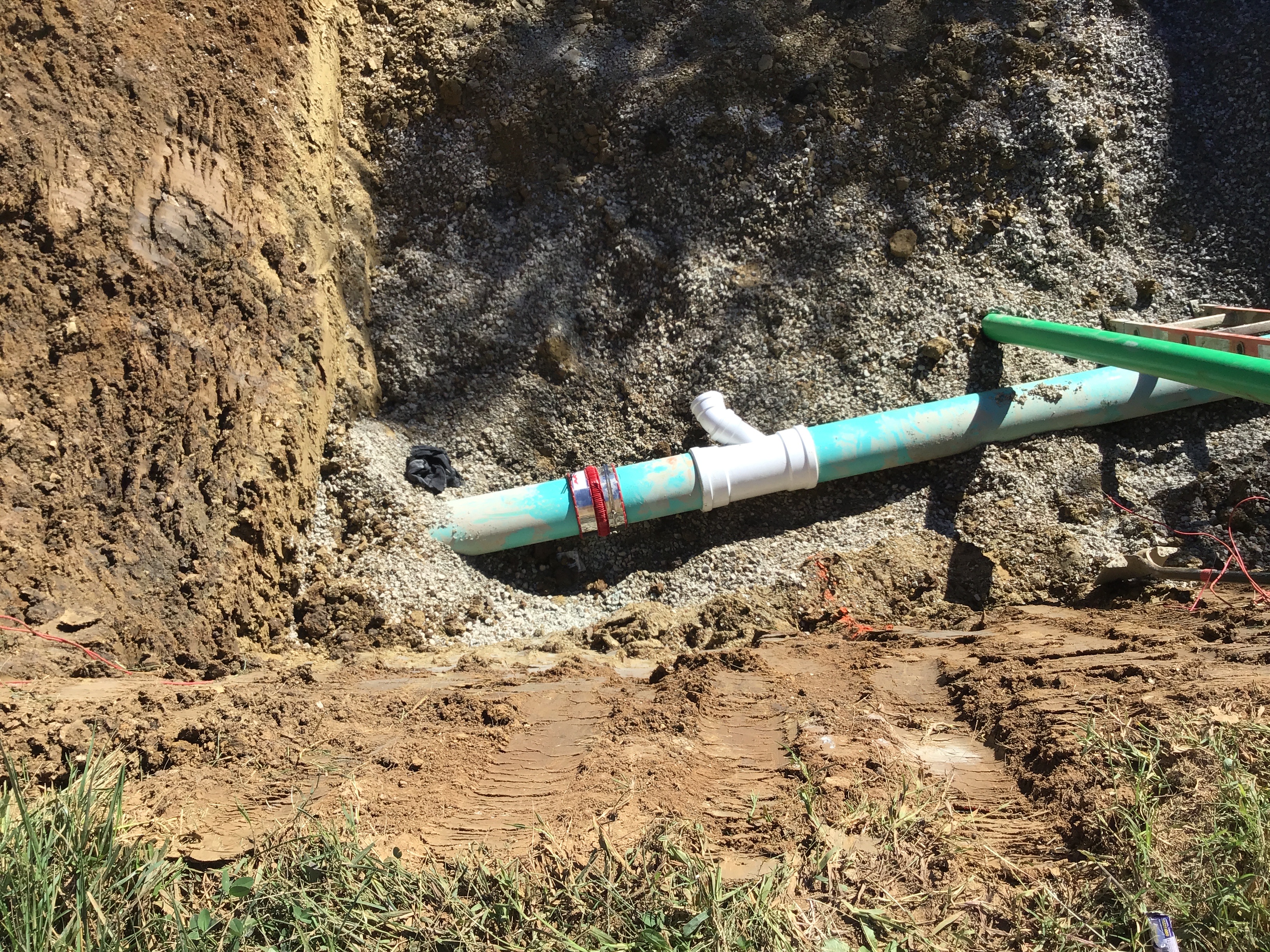

9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today. 2:10PM Contractor back filled excavation and button up for the weekend. Fencing was installed where contractor stopped installation of sanitary Line A.
Sanitary Sewer Construction Inspection Partial 09/29/2020
Misc
Informational
09/25/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/25/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/25/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/25/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/25/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/25/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/25/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/25/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/25/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/25/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
09/25/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
09/25/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
09/29/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Sanitary Sewer Construction Inspection Partial 09/30/2020
Misc
Informational
09/29/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/29/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/29/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/29/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/29/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/29/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/29/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/29/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/29/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/29/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
09/29/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
09/29/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
09/29/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
09/30/2020

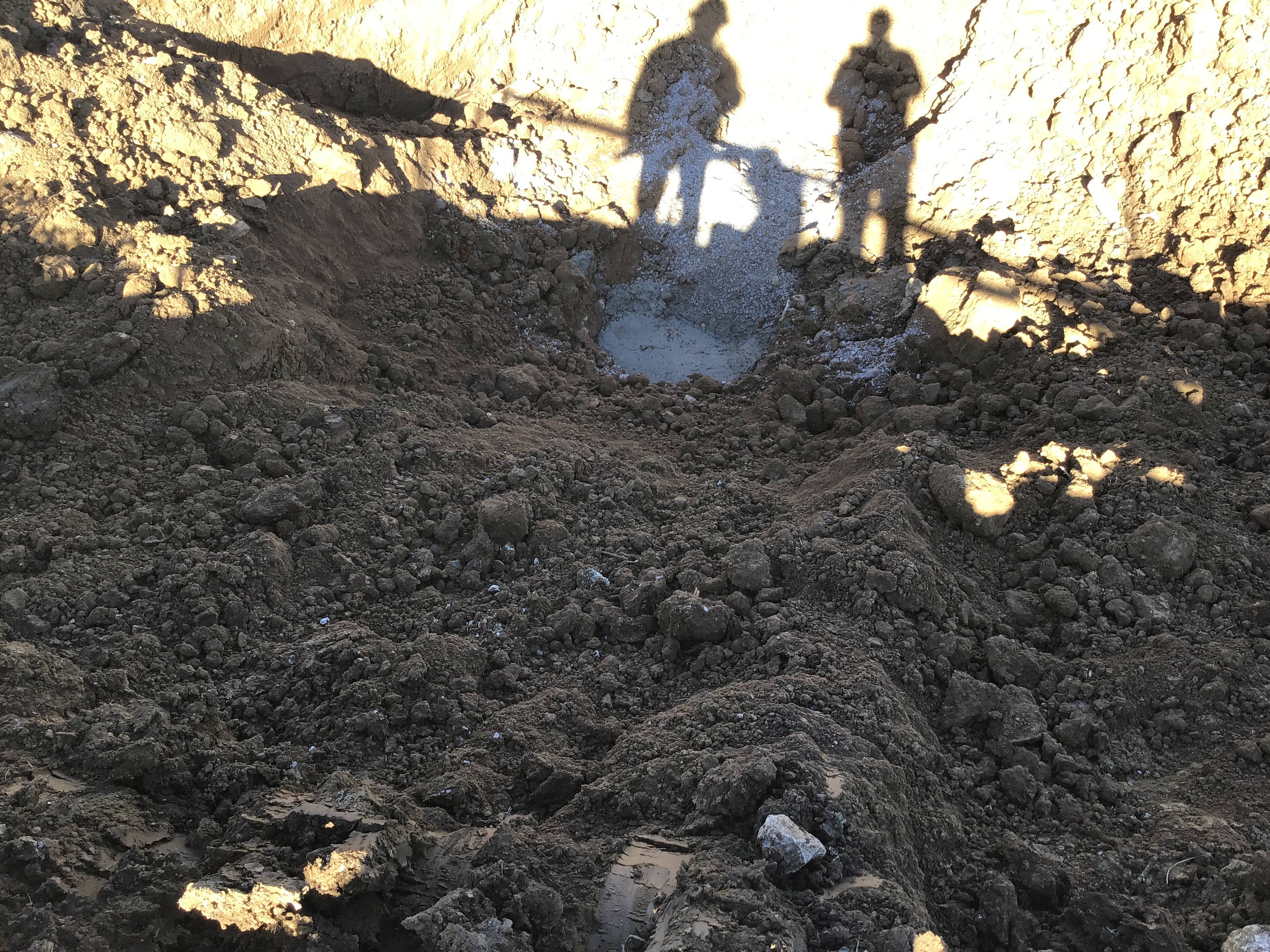

9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Sanitary Sewer Construction Inspection Partial 10/01/2020
Misc
Informational
09/30/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
09/30/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
09/30/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
09/30/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
09/30/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
09/30/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
09/30/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
09/30/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
09/30/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
09/30/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
09/30/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
09/30/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
09/30/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
09/30/2020
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
10/01/2020
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
10/02/2020
10/2/20 Friday Contractor was not able to total complete Laterals on Lot 12 yesterday it is scheduled for completion today. Laterals for Lots 13 & 16 are being installed.
Storm Sewer Construction Inspection Partial 10/05/2020
Misc
Informational
10/05/2020

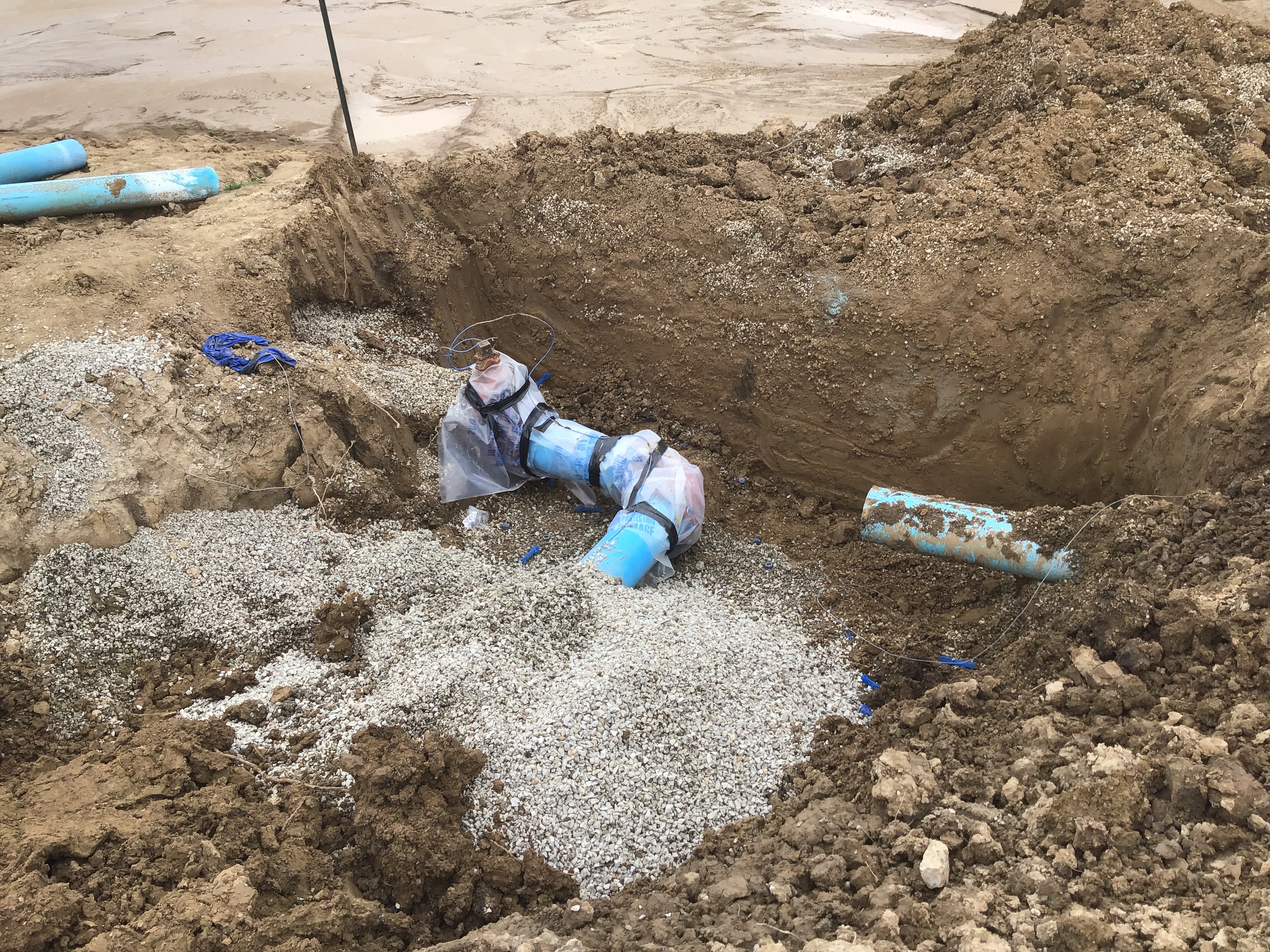

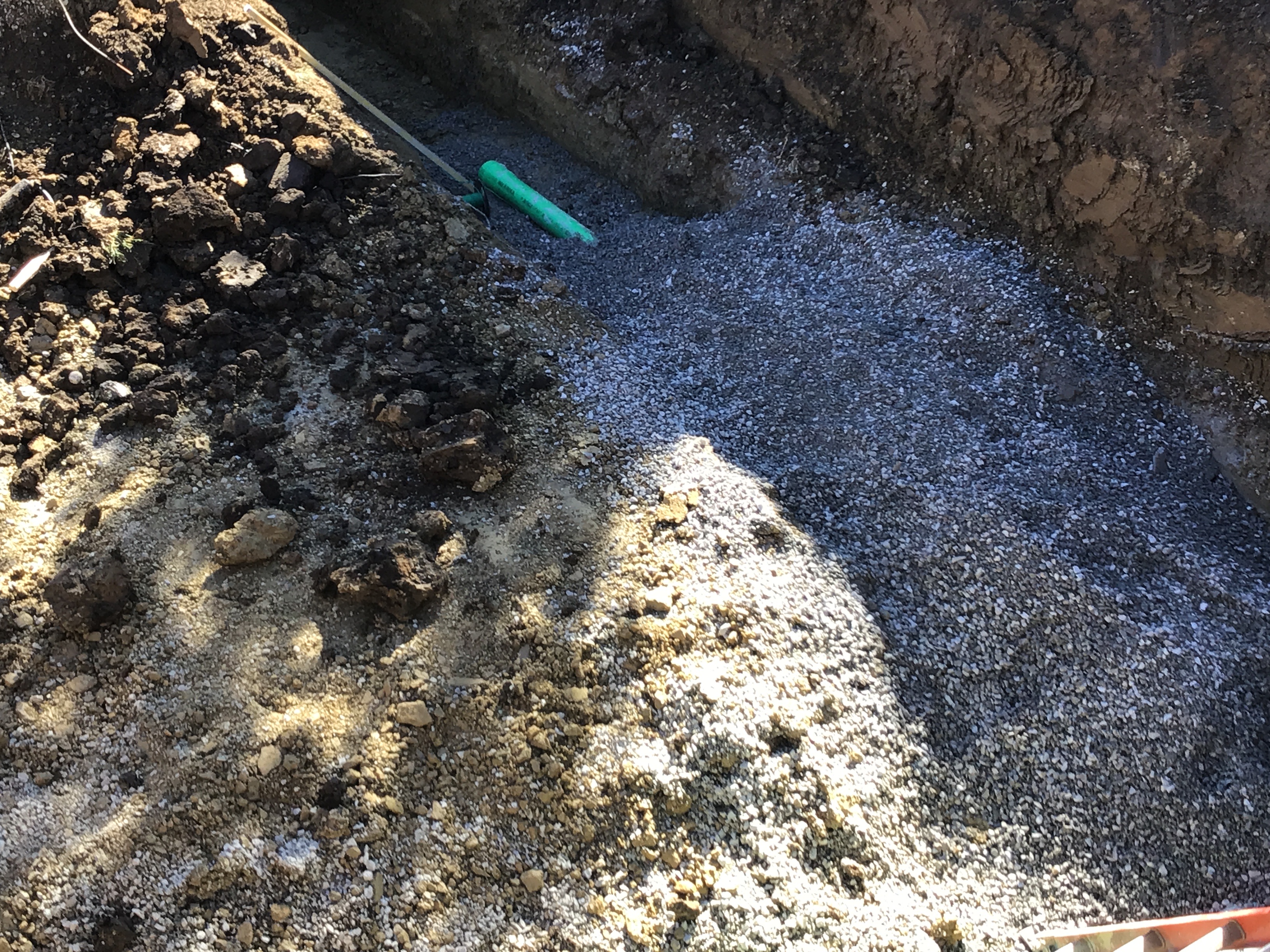

Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Sanitary Sewer Construction Inspection Partial 10/05/2020
Misc
Informational
10/01/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
10/01/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
10/01/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
10/01/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
10/01/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
10/01/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
10/01/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
10/01/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
10/01/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
10/01/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
10/01/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
10/01/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
10/01/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
10/01/2020
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
10/01/2020
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
10/05/2020
Contractor was finishing work on Laterals of Lot 13.
Storm Sewer Construction Inspection Partial 10/06/2020
Misc
Informational
10/05/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/06/2020

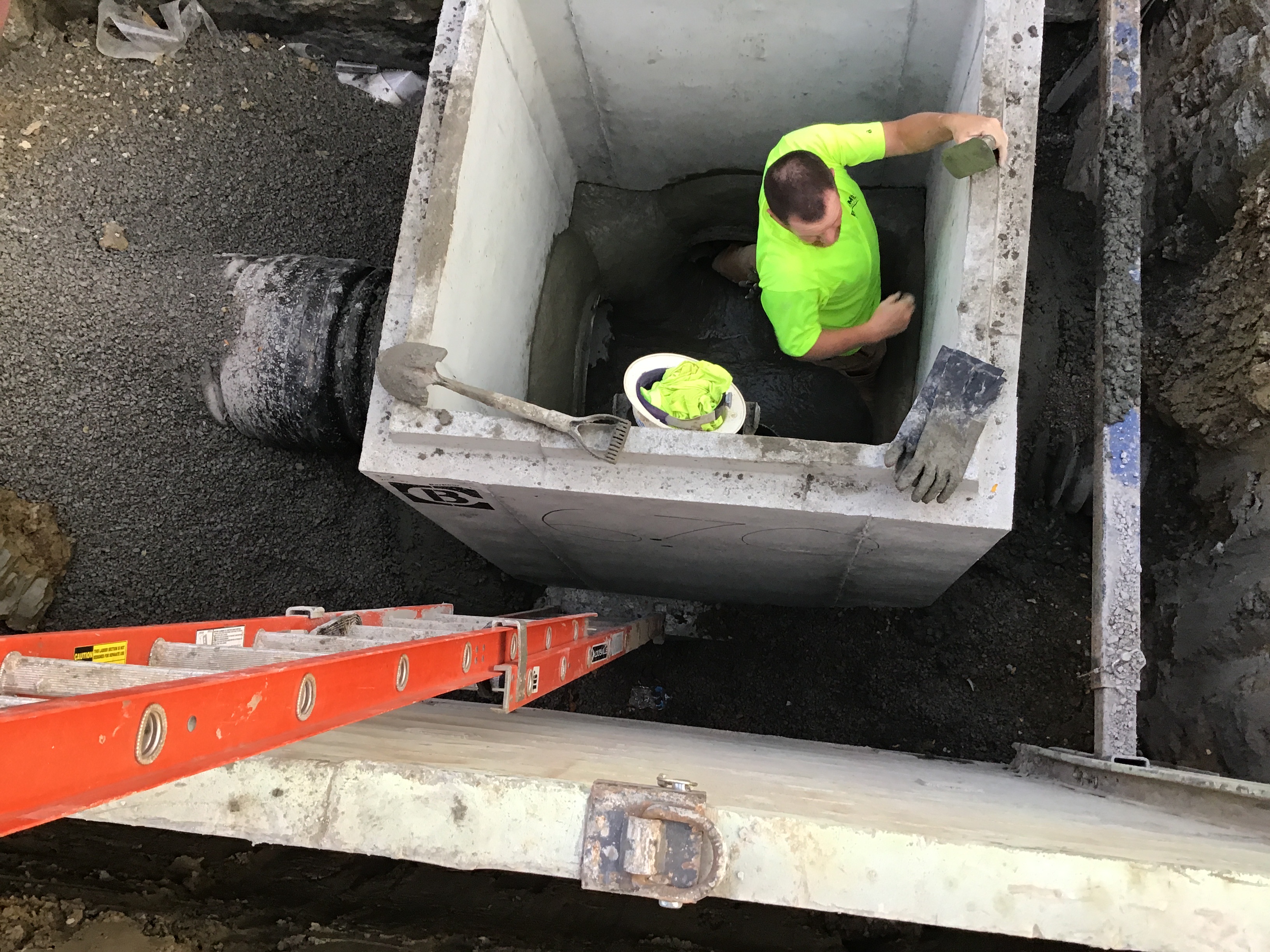

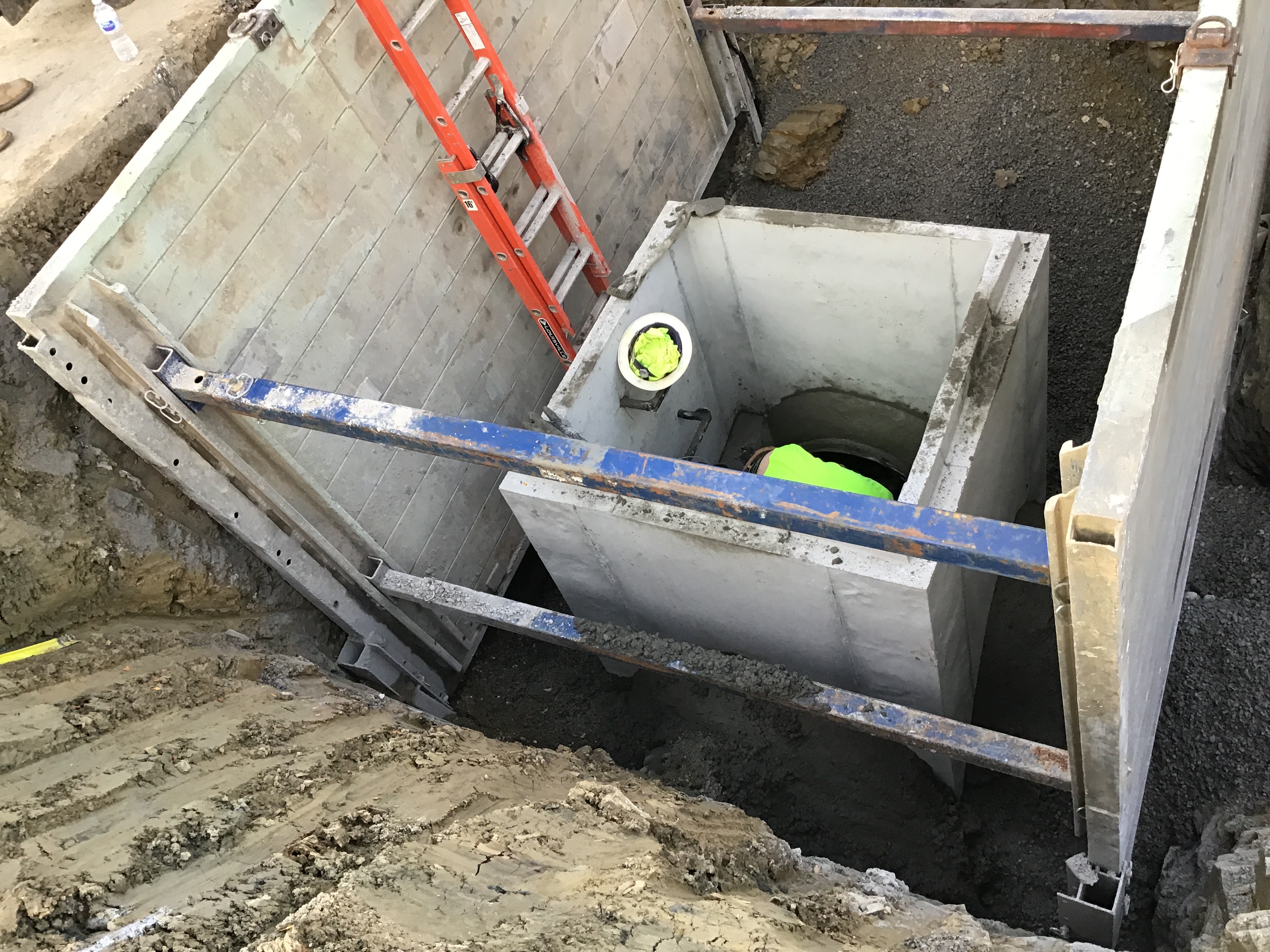

Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Storm Sewer Construction Inspection Partial 10/07/2020
Misc
Informational
10/06/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/06/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/07/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Storm Sewer Construction Inspection Partial 10/08/2020
Misc
Informational
10/07/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/07/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/07/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/08/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Storm Sewer Construction Inspection Partial 10/09/2020
Misc
Informational
10/08/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/08/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/08/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/08/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/09/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Sanitary Sewer Construction Inspection Partial 10/12/2020
Misc
Informational
10/05/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
10/05/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
10/05/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
10/05/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
10/05/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
10/05/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
10/05/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
10/05/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
10/05/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
10/05/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
10/05/2020

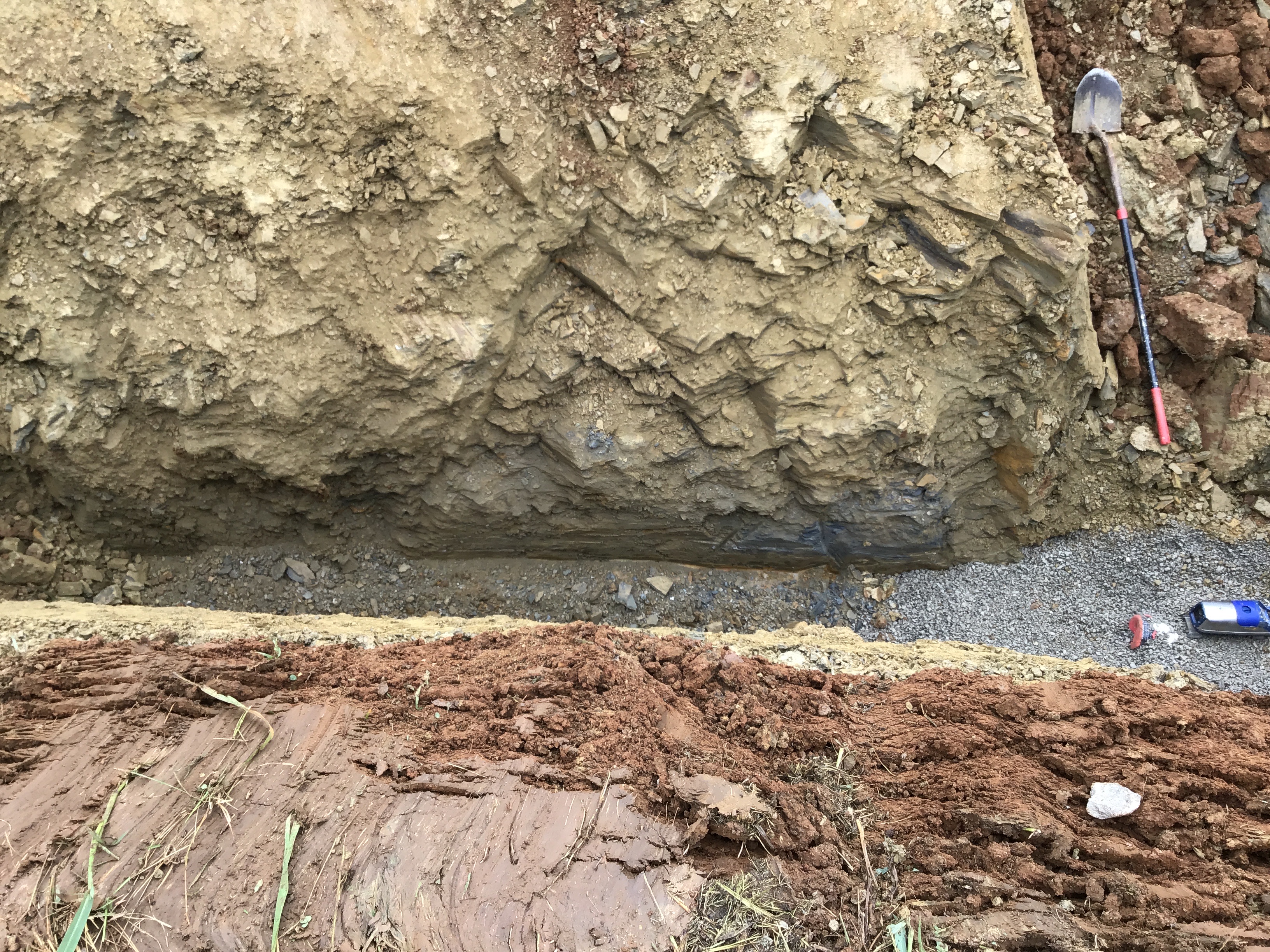

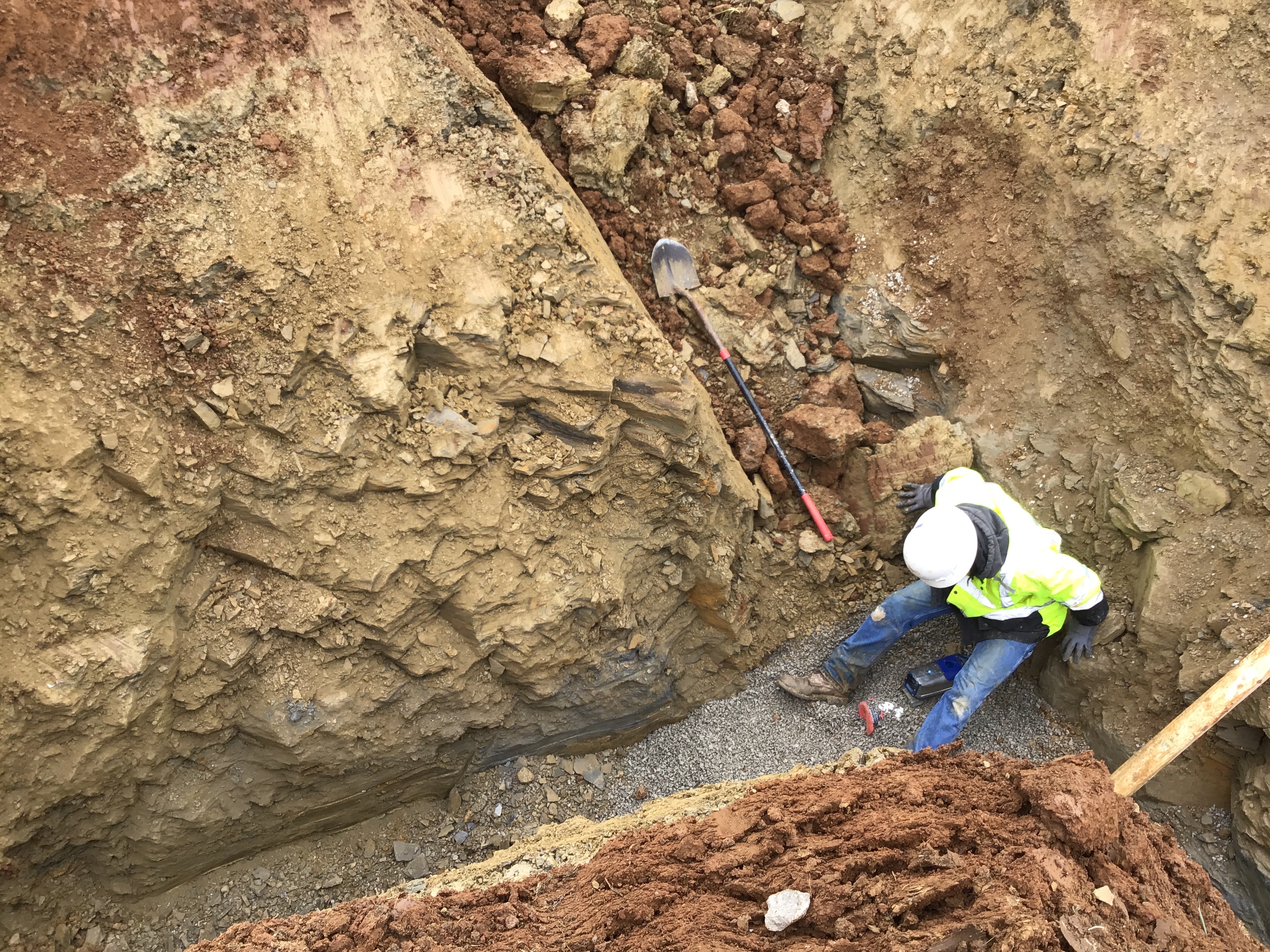

9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
10/05/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
10/05/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
10/05/2020
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
10/05/2020
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
10/05/2020
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
10/12/2020
2 Laterals were installed on existing line for Lot 9.
Storm Sewer Construction Inspection Partial 10/12/2020
Misc
Informational
10/09/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/09/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/09/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/09/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/09/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Storm Sewer Construction Inspection Partial 10/13/2020
Misc
Informational
10/12/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/12/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/12/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/12/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/12/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/13/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Storm Sewer Construction Inspection Partial 10/14/2020
Misc
Informational
10/13/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/13/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/13/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/13/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/13/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/13/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/13/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/14/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Water Line - Construction Inspection Partial 10/15/2020
Misc
Informational
08/04/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
08/04/2020
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
10/15/2020

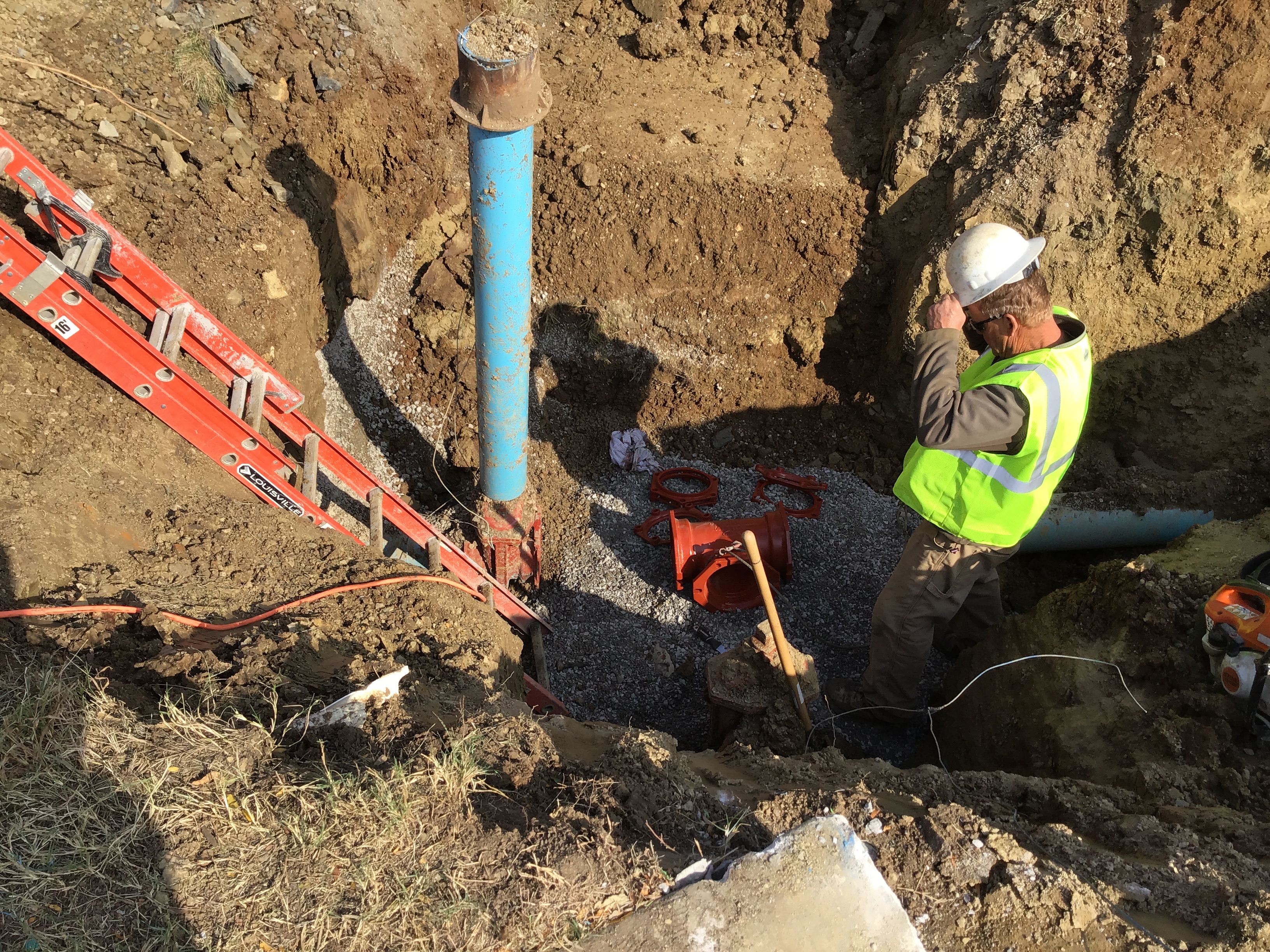

10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Storm Sewer Construction Inspection Partial 10/15/2020
Misc
Informational
10/14/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/14/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/14/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/14/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/14/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/14/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/14/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/14/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/15/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Water Line - Construction Inspection Partial 10/16/2020
Misc
Informational
10/15/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
10/15/2020
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
10/15/2020
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Storm Sewer Construction Inspection Partial 10/16/2020
Misc
Informational
10/15/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/15/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/15/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/15/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/15/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/15/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/15/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/15/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/15/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Storm Sewer Construction Inspection Partial 10/19/2020
Misc
Informational
10/16/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/16/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/16/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/16/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/16/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/16/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/16/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/16/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/16/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Water Line - Construction Inspection Partial 10/19/2020
Misc
Informational
10/16/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
10/16/2020
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
10/16/2020
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Storm Sewer Construction Inspection Partial 10/21/2020
Misc
Informational
10/19/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/19/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/19/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/19/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/19/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/19/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/19/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/19/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/19/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/19/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Storm Sewer Construction Inspection Partial 10/22/2020
Misc
Informational
10/21/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/21/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/21/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/21/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/21/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/21/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/21/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/21/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/21/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/21/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/21/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continued to work through the rock on Storm Line 3.
Grading/Excavation/Fill Inspection Partial 10/22/2020
Misc
Partial Correction
08/26/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
08/26/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
08/26/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
08/26/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
08/26/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor is doing compaction testing with KCTE at the street crossing of utilities.
Erosion Control Inspection Partial 10/23/2020
Misc
Partial Correction
10/23/2020
I will talk with contractor to ensure streets are cleaned up at the end of work day. the forecast of rainy weather will require we stay abreast of the need to frequently clean the streets connected to the site.
Storm Sewer Construction Inspection Partial 10/27/2020
Misc
Informational
10/22/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/22/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/22/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/22/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/22/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/22/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/22/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/22/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/22/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/22/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/22/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/22/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continued to work through the rock on Storm Line 3.
Misc
Informational
10/27/2020
10/27/20 Tuesday Contractor continued to work on Storm Line 3 through the elements and rock.
Storm Sewer Construction Inspection Partial 10/28/2020
Misc
Informational
10/27/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/27/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/27/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/27/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/27/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/27/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/27/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/27/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/27/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/27/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/27/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/27/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Misc
Informational
10/27/2020
10/22/20 Thursday Contractor continued to work through the rock on Storm Line 3.
Misc
Informational
10/27/2020
10/27/20 Tuesday Contractor continued to work on Storm Line 3 through the elements and rock.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor continued to jackhammer rock for Storm Line 3. Contractor began to set concrete and metal storm lids on the project that were delivered. Gravel was placed around the weep hole of the Field Inlets.
Storm Sewer Construction Inspection Partial 10/30/2020
Misc
Informational
10/28/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/28/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/28/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/28/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/28/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/28/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/28/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/28/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/28/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/28/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/28/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/28/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Misc
Informational
10/28/2020
10/22/20 Thursday Contractor continued to work through the rock on Storm Line 3.
Misc
Informational
10/28/2020
10/27/20 Tuesday Contractor continued to work on Storm Line 3 through the elements and rock.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor continued to jackhammer rock for Storm Line 3. Contractor began to set concrete and metal storm lids on the project that were delivered. Gravel was placed around the weep hole of the Field Inlets.
Misc
Informational
10/30/2020
10/30/20 Friday Contractor completed Storm Line 3 and poured inverts and collars. The contractor built the skimmer for Sediment Trap to remain until Phase 3 Ref C 206 also see C 300. Contractor will work Saturday setting lids on storm sewer field inlets.
Storm Sewer Construction Inspection Partial 10/31/2020
Misc
Informational
10/30/2020
Contractor installed approximately 200 of 18” HDPE pipe and 1-2 field Inlet.
Misc
Informational
10/30/2020
Contractor continued installation of Storm Sewer pipe on Lines 1&2. Field Inlets 1-3 & 2-1 Bases were set. Contractor has run into heavy rock during excavation. Approximately 32’ of 18” HPDE, 200’ 15” HDPE was installed on Line #1. Approximately 139’ of 15” HDPE was installed on Line #2.
Misc
Informational
10/30/2020
10/7/20 Wednesday Contractor is finishing Storm Line #2 which includes 35’ of 15” HDPE and Curb Inlet 2-2. Contract preparing to work on Storm Line #3. Talk to project engineer about keeping the existing curb inlet. Project calls for removal and replacement bot that leave that block area with no curb inlet.
Misc
Informational
10/30/2020
10/8/20 Thursday Contractor installed approximately 280’ of 15” HDPE on Storm Line 1. Contractor working to install Junction box 3-2 on Existing Storm Line as-per project plan. Contractor will work to set Junction box due to early call for concrete.
Misc
Informational
10/30/2020
Contractor installed Junction box 3-2 and poured collars and inverts on inlet piping. Contractor Demo the existing 15” HPDE on existing curb inlet. The three curb inlets and storm pie was Demo along NE Ralph Powell RD of the project. Storm Line 1 contractor ran into a heavy amount of rock and had to jackhammer to excavate to install the approximately 60’ of 15” HDPE Storm Line 1. Curb Inlet 1-4 was installed.
Misc
Informational
10/30/2020
10/12/20 Monday Contractor installed approximately 130’ of 15” HDPE of Storm Line 3.
Misc
Informational
10/30/2020
10/13/20 Tuesday Contractor installed Curb Inlet 4-2 & approximately 100’ of 15” HDPE on Storm Line 4.
Misc
Informational
10/30/2020
10/14/20 Wednesday Contractor installed Curb Inlets 4-3 & 5-1. The 15” HDPE was complete up to the newly installed Curb Inlet 4-3. 35’ of 15” HDPE was installed between Curb Inlets 4-2 & 5-1.
Misc
Informational
10/30/2020
10/15/20 Thursday Curb Inlet 4-4 &135’ of 15” HDPE installed from 4-3 to 4-4. Flared End section were installed on Lines 1&4. Contractor will begin to pour inverts after lunch.
Misc
Informational
10/30/2020
10/16/20 Friday Contractor completed installation of Storm Line 3 from Junction Box 3-2 to Field Inlet 3-3.
Misc
Informational
10/30/2020
10/19/20 Monday Contractor continued installation of Storm line 3 from field Inlet 3-3, and began work on Storm line 6. Detention Outlet Control Structure 6-2 was set in place.
Misc
Informational
10/30/2020
10/21/20 Wednesday Contractor continued to construct Detention Outlet Control Structure 6-2 10/20/20. The contractor also continued to work on Storm Line 3.
Misc
Informational
10/30/2020
10/22/20 Thursday Contractor continued to work through the rock on Storm Line 3.
Misc
Informational
10/30/2020
10/27/20 Tuesday Contractor continued to work on Storm Line 3 through the elements and rock.
Misc
Informational
10/30/2020
10/28/20 Wednesday Contractor continued to jackhammer rock for Storm Line 3. Contractor began to set concrete and metal storm lids on the project that were delivered. Gravel was placed around the weep hole of the Field Inlets.
Misc
Informational
10/30/2020
10/30/20 Friday Contractor completed Storm Line 3 and poured inverts and collars. The contractor built the skimmer for Sediment Trap to remain until Phase 3 Ref C 206 also see C 300. Contractor will work Saturday set lids on storm sewer field inlets.
Misc
Informational
10/31/2020
10/31/20 Saturday Contractor backfilled Field Inlets on Storm Line 3 and graded surrounding area.
Grading/Excavation/Fill Inspection Partial 11/02/2020
Misc
Partial Correction
10/22/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
10/22/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
10/22/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
10/22/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
10/22/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor is doing compaction testing with KCTE at the street crossing of utilities.
Misc
Informational
11/02/2020
Contractor worked on grading of site.
Grading/Excavation/Fill Inspection Partial 11/11/2020
Misc
Partial Correction
11/02/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
11/02/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
11/02/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
11/02/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
11/02/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Misc
Informational
11/02/2020
10/22/20 Thursday Contractor is doing compaction testing with KCTE at the street crossing of utilities.
Misc
Informational
11/02/2020
Contractor worked on grading of site.
Misc
Informational
11/11/2020
11/11/20 Wednesday Spaulding is removing and grading site. Beemer is not working o site today.
Grading/Excavation/Fill Inspection Partial 11/12/2020
Misc
Partial Correction
11/11/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
11/11/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
11/11/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
11/11/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
11/11/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Misc
Informational
11/11/2020
10/22/20 Thursday Contractor is doing compaction testing with KCTE at the street crossing of utilities.
Misc
Informational
11/11/2020
Contractor worked on grading of site.
Misc
Informational
11/11/2020
11/11/20 Wednesday Spaulding is removing and grading site. Beemer is not working on site today.
Misc
Informational
11/12/2020
11/12/20 Thursday Continued mass grading on project site.
Grading/Excavation/Fill Inspection Partial 11/13/2020
Misc
Partial Correction
11/12/2020
8/17/20 Monday 10:51AM Contractor excavating site. Contractor needs to install a Portal Potty onsite.
Misc
Partial Correction
11/12/2020
8/18/20 Tuesday 7:55AM I have informed one of the rough graders that a need Portal Potty is required on active sites. Contractor is continue rough grading of lots. KC Testing Inc. was onsite yesterday taking density test.
Misc
Partial Correction
11/12/2020
8/20/20 Thursday 9:00AM Contractor has continued to rough grade site. Site still doesn’t have a Portal Potty on site.
Misc
Informational
11/12/2020
8/21/20 Friday 8:35AM Contractor continued to grade site. Portal Potty was onsite since 8/18/20 Tuesday.
Misc
Informational
11/12/2020
8/26/20 Wednesday 1:08PM Contractor continues to grade swell, and contour elevation on site. This is the only work that has been for the past few weeks.
Misc
Informational
11/12/2020
10/22/20 Thursday Contractor is doing compaction testing with KCTE at the street crossing of utilities.
Misc
Informational
11/12/2020
Contractor worked on grading of site.
Misc
Informational
11/12/2020
11/11/20 Wednesday Spaulding is removing and grading site. Beemer is not working on site today.
Misc
Informational
11/12/2020
11/12/20 Thursday Continued mass grading on project site.
Misc
Informational
11/13/2020
11/13/20 Friday Continued grading on project site.
Pavement-Stabilized Subgrade Partial 11/18/2020
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor (Spaulding) is applying the Chemicals stabilization of the subgrade for the streets.Side note: I have reinforced that all ditch check need to be completed (I called The Foreman Ben Richardson for Beemer today).
Curb - Proof Roll Passed 11/19/2020
Misc
Informational
11/19/2020
11/19/20 Thursday Proof rolled sub grade for curbs to be installed, also proof roll of base rock will still need to be done.
Pavement-Aggregate Base Partial 11/20/2020
Misc
Informational
11/20/2020
11/20/20 Friday Contractor installing base rock on streets project.
Curb - Proof Roll Passed 11/30/2020
Misc
Informational
11/30/2020
Misc
Informational
11/30/2020
Proof roll passed inspection.
Public Curb Inspection Partial 12/05/2020
Misc
Informational
12/05/2020
12/5/20 Saturday 7:30 AM Contractor will be pouring public curbs as per project plans for subdivision Chapel Ridge - 2nd Plat.
Pavement-Stabilized Subgrade Passed 12/08/2020
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor (Spaulding) is applying the Chemicals stabilization of the subgrade for the streets.Side note: I have reinforced that all ditch check need to be completed (I called The Foreman Ben Richardson for Beemer today).
Misc
Informational
11/19/2020
Passed
Pavement-Proof Roll Passed 12/08/2020
Misc
Informational
12/08/2020
12/8/20 Tuesday 2:40 PM Proof Roll passed inspection.
Pavement-Aggregate Base Partial 12/09/2020
Misc
Informational
11/20/2020
11/20/20 Friday Contractor installing base rock on streets project.
Misc
Informational
12/09/2020

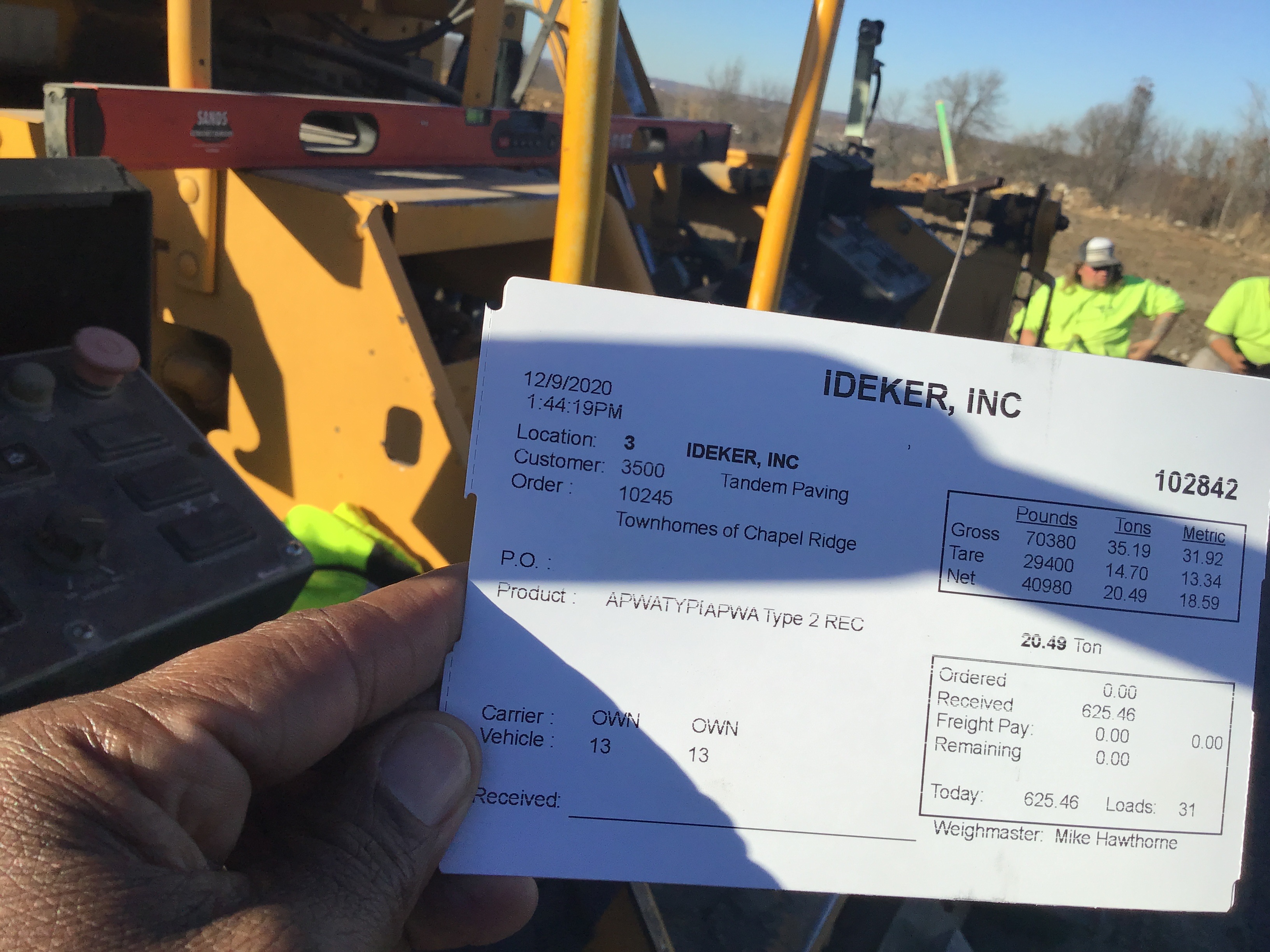

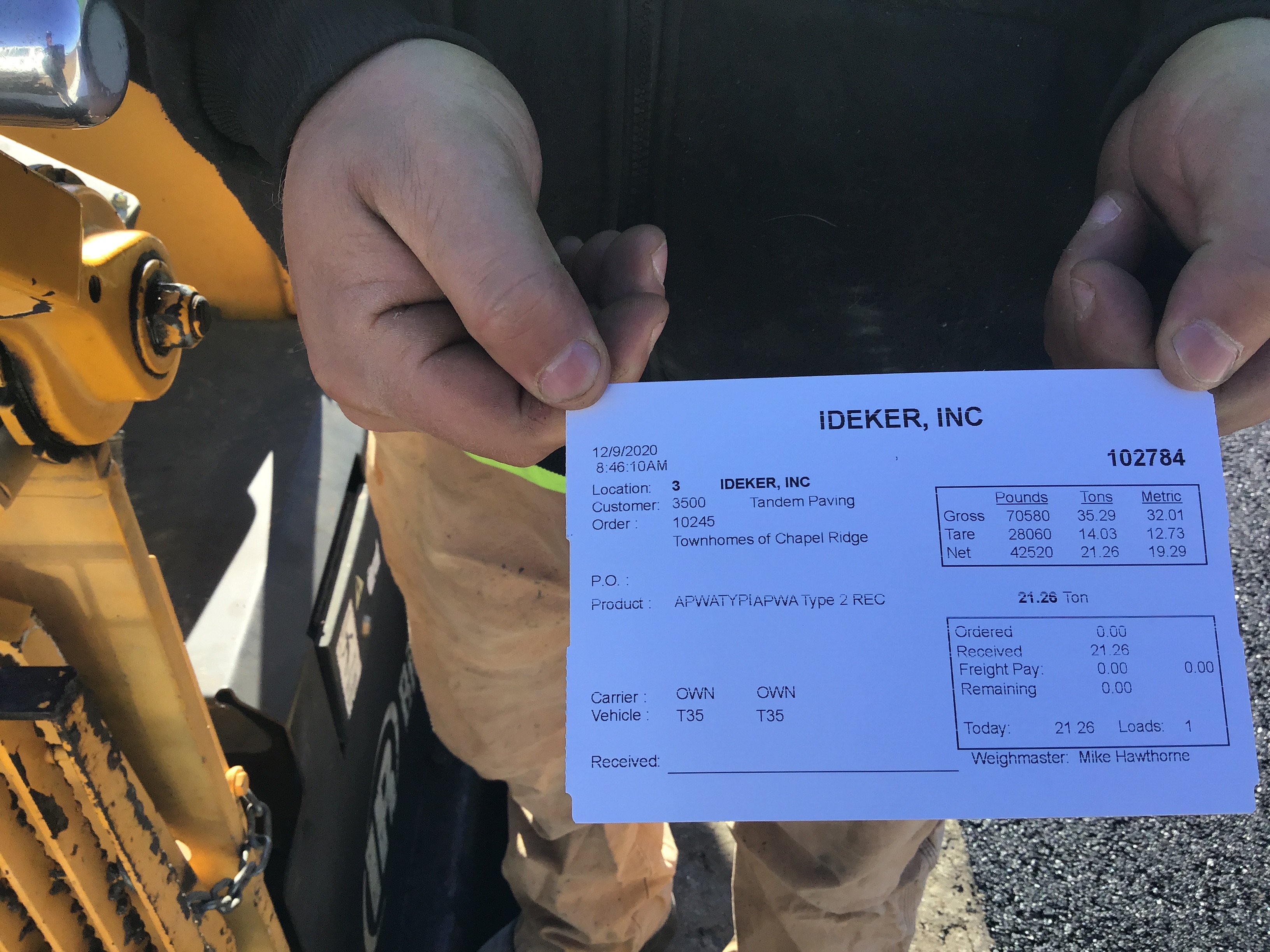

12/8/20 Wednesday Contractor ( Tandem Paving CO. ) is laying asphalt base on project 4” lifts.
Pavement-Aggregate Base Passed 12/09/2020
Misc
Informational
12/09/2020
11/20/20 Friday Contractor installing base rock on streets project.
Misc
Informational
12/09/2020
12/8/20 Wednesday Contractor ( Tandem Paving CO. ) is laying asphalt base on project 4” lifts.
Misc
Informational
12/09/2020
12/8/20 Tuesday 2:15PM Contractor has completed the Aggregate base and will start the surface asphalt.
Pavement-Surface Partial 12/09/2020
Misc
Informational
12/09/2020
12/9/20 Wednesday 5:09PM Contractor started Surface asphalt aggregate after the completion of Base asphalt aggregate. The last asphalt truck arrived for the day arrived at 5:20PM
Pavement-Surface Partial 12/10/2020
Misc
Informational
12/09/2020
12/9/20 Wednesday 5:09PM Contractor started Surface asphalt aggregate after the completion of Base asphalt aggregate. The last asphalt truck arrived for the day arrived at 5:20PM
Misc
Informational
12/10/2020
12/10/20 Thursday 10:15PM Contractor was applying tack coat to project street not covered with surface asphalt on 12/9/20. Contractor will complete surface asphalt today.
Pavement-Surface Passed 12/10/2020
Misc
Informational
12/10/2020
12/9/20 Wednesday 5:09PM Contractor started Surface asphalt aggregate after the completion of Base asphalt aggregate. The last asphalt truck arrived for the day arrived at 5:20PM
Misc
Informational
12/10/2020
12/10/20 Thursday 10:15PM Contractor was applying tack coat to project street not covered with surface asphalt on 12/9/20. Contractor will complete surface asphalt today.
Misc
Informational
12/10/2020
COMPLETED
Site Visit Complete 01/20/2021
Misc
Informational
01/20/2021
Met with contractor to discuss the installation of water main & ditch checks for sanitary main.
Sanitary Sewer Construction Inspection Partial 01/21/2021
Misc
Informational
10/12/2020
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
10/12/2020
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
10/12/2020
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
10/12/2020
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
10/12/2020
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
10/12/2020
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
10/12/2020
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
10/12/2020
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
10/12/2020
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
10/12/2020
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
10/12/2020
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
10/12/2020
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
10/12/2020
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
10/12/2020
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
10/12/2020
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
10/12/2020
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
10/12/2020
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
01/21/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Sanitary Sewer Construction Inspection Partial 01/28/2021
Misc
Informational
01/21/2021
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
01/21/2021
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
01/21/2021
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
01/21/2021
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
01/21/2021
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
01/21/2021
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
01/21/2021
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
01/21/2021
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
01/21/2021
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
01/21/2021
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
01/21/2021
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
01/21/2021
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
01/21/2021
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
01/21/2021
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
01/21/2021
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
01/21/2021
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
01/21/2021
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
01/21/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Misc
Informational
01/28/2021
1/28/21 Thursday Contractor (Beemer Const.) poured ditch checks finished Lot 17 (3), 14 & 15 (1,2, &, 3). Cold weather.
Sanitary Sewer Construction Inspection Partial 01/29/2021
Misc
Informational
01/28/2021
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
01/28/2021
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
01/28/2021
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
01/28/2021
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
01/28/2021
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
01/28/2021
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
01/28/2021
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
01/28/2021
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
01/28/2021
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
01/28/2021
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
01/28/2021
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
01/28/2021
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
01/28/2021
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
01/28/2021
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
01/28/2021
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
01/28/2021
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
01/28/2021
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
01/28/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Misc
Informational
01/28/2021
1/28/21 Thursday Contractor (Beemer Const.) poured ditch checks finished Lot 17 (3), 14 & 15 (1,2, &, 3). Cold weather.
Misc
Informational
01/29/2021
1/29/21 Thursday Contractor (Beemer Const.) backfilled excavation.
Sanitary Sewer Construction Inspection Partial 02/02/2021
Misc
Informational
01/29/2021
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
01/29/2021
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
01/29/2021
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
01/29/2021
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
01/29/2021
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
01/29/2021
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
01/29/2021
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
01/29/2021
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
01/29/2021
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
01/29/2021
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
01/29/2021
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
01/29/2021
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
01/29/2021
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
01/29/2021
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
01/29/2021
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
01/29/2021
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
01/29/2021
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
01/29/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Misc
Informational
01/29/2021
1/28/21 Thursday Contractor (Beemer Const.) poured ditch checks finished Lot 17 (3), 14 & 15 (1,2, &, 3). Cold weather.
Misc
Informational
01/29/2021
1/29/21 Thursday Contractor (Beemer Const.) backfilled excavation.
Misc
Informational
02/01/2021

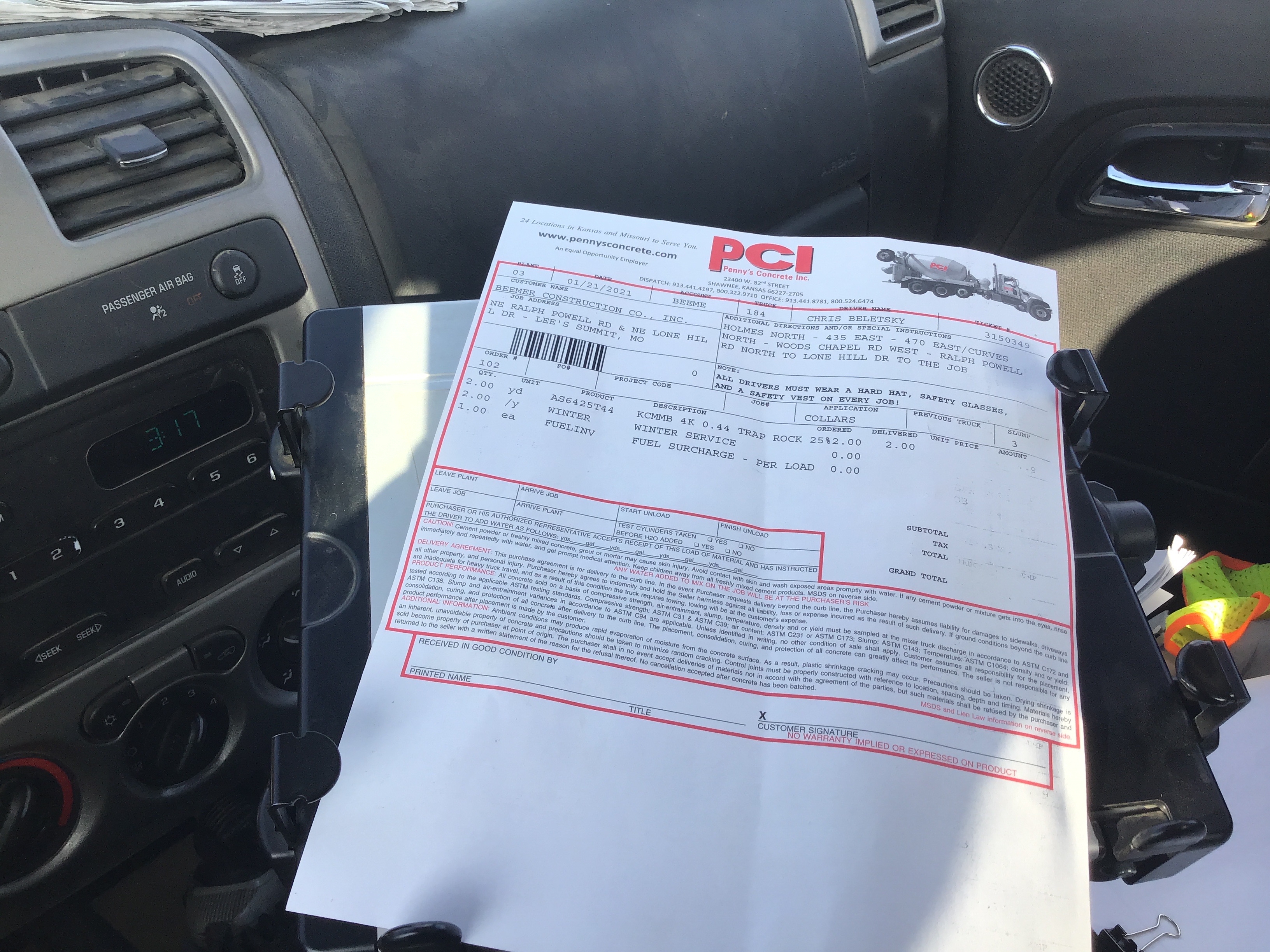

2/1/21 Monday Contractor excavated sanitary line to pour ditch checks on Lots 13, 12, 11, & 10.
Misc
Informational
02/02/2021
Sanitary Sewer Construction Inspection Partial 02/02/2021
Misc
Informational
02/02/2021
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
02/02/2021
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
02/02/2021
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
02/02/2021
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
02/02/2021
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
02/02/2021
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
02/02/2021
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
02/02/2021
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
02/02/2021
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
02/02/2021
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
02/02/2021
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
02/02/2021
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
02/02/2021
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
02/02/2021
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
02/02/2021
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
02/02/2021
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
02/02/2021
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
02/02/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Misc
Informational
02/02/2021
1/28/21 Thursday Contractor (Beemer Const.) poured ditch checks finished Lot 17 (3), 14 & 15 (1,2, &, 3). Cold weather.
Misc
Informational
02/02/2021
1/29/21 Thursday Contractor (Beemer Const.) backfilled excavation.
Misc
Informational
02/02/2021
2/1/21 Monday Contractor excavated sanitary line to pour ditch checks on Lots 13, 12, 11, & 10.
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor poured ditch checks on Lots 23, 24, 10, 11, 12, & 13.
Sanitary Sewer Construction Inspection Partial 02/03/2021
Misc
Informational
02/02/2021
9/4/20 Friday 1:00PM Construction on 8” sanitary Line “B” from MH 2 to and through the installation of MH 3. Contractor continues to install line and will begin to install laterals for Lots 15 and 14. Contractor plans on working Saturday.
Misc
Informational
02/02/2021
9/8/20 Tuesday 11:30AM Beemer Const. Has installed all wyes on new Line “B” and is projected to finish installing new MH B-4 today.
Misc
Informational
02/02/2021
9/9/20 8:25AM (Beemer Const.) Contractor completed the installation of sanitary Line “B”. Contractor began install Line “A” at the existing manholes.
Misc
Informational
02/02/2021
9/15/20 3:10PM 9/14/20 Contractor installed approximately 60’ of 8” SDR-26 pipe on Line A and lateral line for Lot 24. 9/15/20 Contractor sawed existing invert to make a correct opening for that was cored to compile with design construction standard. Some excavation work was performed.
Misc
Informational
02/02/2021
9/16/20 Wednesday Contractor installed MH A-1 and approximately 90’ of 8” SDR-26 PVC on sanitary Line A . Lot 19 (1-3) lateral line was installed, and Lot 10 (1-3) lateral line.
Misc
Informational
02/02/2021
9/17/20 3:07PM Thursday Contractor installed approximately 50’ of 8” SDR-26 PVC on sanitary Line A. Lot 19 (2-3) & (3-3) and Lot 10 (2-3) & (3-3) lateral lines.
Misc
Informational
02/02/2021
9/18/20 2:53 Friday Contractor installed approximately 60” of 8” SDR-26 PVC on sanitary Line A. Lot 11 (1-3) & Lot 18 (1-3) Lateral lines were installed.
Misc
Informational
02/02/2021
9/21/20 Monday Contractor (Beemer Const.) installed approximately 63’ of 8” SDR-26 PVC. Lot 18 lateral lines 2-3 & 3-3 and Lot 11 lateral lines 2-3 & 3-3.
Misc
Informational
02/02/2021
9/22/20 Tuesday Contractor installed approximately 34’ of 8” of SDR-26 PVC. Lot 17 lateral 1-3 was complete. MH A-2 was installed.
Miscellaneous Correction
Informational
02/02/2021
9/23/20 Wednesday Contractor actual finished the install Lot 11 laterals 2-3 & 3-3 today and Lot 18 lateral 3-3 was completed 9/22/20. Lot 17 lateral 1-3 was not completed on 9/22/20. NE Ralph Powell RD north of NE Lone Hill Dr street was removed as per project plans.
Misc
Informational
02/02/2021
9/24/20 Thursday Progress has been slow due to contractor hit large amounts of rock.
Misc
Informational
02/02/2021
9/25/20 Friday 11:40AM Lateral 1-3 was installed for Lot 12 it appears that the breaker are being repaired. I am unsure about how much work will be accomplished concerning the sanitary line today.
Misc
Informational
02/02/2021
9/29/20 Tuesday Contractor still working through hard rock, progress has been greatly slowed contractor is trying to complete Laterals for Lot 12 & 17.
Misc
Informational
02/02/2021
9/30/20 Wednesday Contractor (Beemer Const.) was able to install approximately 56’ of 8” SDR-26 PVC on Sanitary Line “A” Sta 6+50. Contractor is still working to install Laterals for Lot 12 & 17.
Misc
Informational
02/02/2021
10/1/20 Thursday Contractor installed approximately 91’ of 8” SDR-26 PVC and began to install MH A-3. Lots12 &17 Laterals were complete.
Misc
Informational
02/02/2021
Contractor was finishing work on Laterals of Lot 13.
Misc
Informational
02/02/2021
2 Laterals were installed on existing line for Lot 9.
Misc
Informational
02/02/2021
1/21/21 Thursday Contractor (Beemer Const.) poured ditch checks for 16(1,2,3) 17(1,2, was not poured 3)& 18(1,2,3). Contractor will backfill excavation when ditch checks setup.
Misc
Informational
02/02/2021
1/28/21 Thursday Contractor (Beemer Const.) poured ditch checks finished Lot 17 (3), 14 & 15 (1,2, &, 3). Cold weather.
Misc
Informational
02/02/2021
1/29/21 Thursday Contractor (Beemer Const.) backfilled excavation.
Misc
Informational
02/02/2021
2/1/21 Monday Contractor excavated sanitary line to pour ditch checks on Lots 13, 12, 11, & 10.
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor poured ditch checks on Lots 23, 24, 10, 11, 12, & 13.
Misc
Informational
02/03/2021
2/3/21 Wednesday Contractor backfilled sanitary excavation.
Water Line - Construction Inspection Partial 02/05/2021
Misc
Informational
10/19/2020
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
10/19/2020
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
10/19/2020
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
10/19/2020
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/05/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Water Line - Construction Inspection Partial 02/22/2021
Misc
Informational
02/05/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
02/05/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
02/05/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
02/05/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
02/05/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/05/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
02/22/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Water Line - Construction Inspection Partial 02/23/2021
Misc
Informational
02/22/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
02/22/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
02/22/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
02/22/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
02/22/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/22/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
02/22/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
02/23/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Water Line - Construction Inspection Partial 02/24/2021
Misc
Informational
02/23/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
02/23/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
02/23/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
02/23/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
02/23/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/23/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
02/23/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
02/23/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
02/24/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Water Line - Construction Inspection Partial 02/25/2021
Misc
Informational
02/24/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
02/24/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
02/24/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
02/24/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
02/24/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/24/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
02/24/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
02/24/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
02/24/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
02/25/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Water Line - Construction Inspection Partial 03/01/2021
Misc
Informational
02/25/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
02/25/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
02/25/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
02/25/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
02/25/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
02/25/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
02/25/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
02/25/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
02/25/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
02/25/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/01/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Water Line - Construction Inspection Partial 03/02/2021
Misc
Informational
03/01/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/01/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/01/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
03/01/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/01/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/01/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/01/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/01/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/01/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/01/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/01/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/02/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Water Line - Construction Inspection Partial 03/03/2021
Misc
Informational
03/02/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/02/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/02/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
03/02/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/02/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/02/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/02/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/02/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/02/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/02/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/02/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/02/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Misc
Informational
03/03/2021
3/3/21 Wednesday City of Lee’s Summit installed construction tap on newly installed Water Main to perform test.
Water Line - Hydrostatic Test Passed 03/08/2021
Misc
Informational
03/08/2021
Contractor pressure tested project water main as per plan at 150 Psi and passed.
Water Line - Construction Inspection Partial 03/08/2021
Misc
Informational
03/03/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/03/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/03/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM. Add information on 9/1/21 Crossing was not removed but the abandoned side of water main was cap and a thrust block poured behind cap @ the intersection of NE Lone Hill Dr & NE Ralph Powell Rd.
Misc
Informational
03/03/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/03/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/03/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/03/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/03/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/03/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/03/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/03/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/03/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Misc
Informational
03/03/2021
3/3/21 Wednesday City of Lee’s Summit installed construction tap on newly installed Water Main to perform test.
Misc
Informational
03/08/2021
3/8/21 Monday Chlorination of water line was complete @ 1:00PM.
Water Line - Coliform Test 1 Partial 03/10/2021
Misc
Informational
03/10/2021
3/10/21 Wednesday Contractor took samples for the first Coliform test. ( Conditions were very windy and dusty ).
Water Line - Coliform Test 2 Partial 03/11/2021
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Beemer Jim Wolken ) took samples and relinquish them to me to transport to the lab.
Water Line - Construction Inspection Partial 03/16/2021
Misc
Informational
03/08/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/08/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/08/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
03/08/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/08/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/08/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/08/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/08/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/08/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/08/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/08/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/08/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Misc
Informational
03/08/2021
3/3/21 Wednesday City of Lee’s Summit installed construction tap on newly installed Water Main to perform test.
Misc
Informational
03/08/2021
3/8/21 Monday Chlorination of water line was complete @ 1:00PM.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor ( Beemer - Jim Wolken crew ) preformed tie-in NE Sagamore Dr near the existing Fire Hydrant 008-151FH. Contractor will complete second tie-in at a later date due to the poor ground conditions caused by rainy weather.
Water Line - Construction Inspection Partial 03/16/2021
Misc
Informational
03/16/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/16/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/16/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
03/16/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/16/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/16/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/16/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/16/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/16/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/16/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/16/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/16/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Misc
Informational
03/16/2021
3/3/21 Wednesday City of Lee’s Summit installed construction tap on newly installed Water Main to perform test.
Misc
Informational
03/16/2021
3/8/21 Monday Chlorination of water line was complete @ 1:00PM.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor ( Beemer - Jim Wolken crew ) preformed tie-in NE Sagamore Dr near the existing Fire Hydrant 008-151FH. Contractor will complete second tie-in at a later date due to the poor ground conditions caused by rainy weather.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor installed 17’ of 8” PVC between two 90 degree and 9’ to the 8’x6’ Tee to the Hydrant Assembly ( This is to be reflect on the As-Built ). Backing block will be poured behind the two 90 deg and 8’x6’ Tee at 1:00PM 3/16/21.
Erosion Control Inspection Partial 03/18/2021
Misc
Corrective Action Required
03/18/2021
3/18/21 Thursday Many curb inlet gutter buddies were filled with soil on project.
Water Line - Construction Inspection Partial 03/22/2021
Misc
Informational
03/16/2021
8/3/20 Monday contractor (Beemer Const.) continues to excavate existing water line. Contractor work approximately 5 hours Saturday 8/1/20 and removed approximately 100’ of existing water line.
Misc
Informational
03/16/2021
8/4/20 Tuesday Contractor (Beemer Const.) Removed approximately 220’ of existing water main yesterday and another 100’ today. This has completed the removal of existing water main for the project.
PW-Main inspection
Informational
03/16/2021
10/15/20 Thursday Water shut on for Line 3 to remove Cross and replace with a 8”x8” Tee with a thrust back behind it. Shut is schedule from 9:00 AM to 1:00PM.
Misc
Informational
03/16/2021
10/16/20 Friday Contractor installed approximately 80’ of 8” PVC water main on Line 3 @ street crossing.
Misc
Informational
03/16/2021
10/19/20 Monday Contractor installed Water Line 2 street crossing of NE Chapel Ridge Pl.
Misc
Informational
03/16/2021
2/5/21 Friday Contractor (Beemer) began installation of 8” PVC water main @ Sta 0+70 to 3+35 Line 2. Contractor backfilled excavation to prepare for the forecasted inclement weather.
Misc
Informational
03/16/2021
2/22/21 Monday Contractor (Beemer) installed FH Assembly @Sta 3+59.63 Line #2 and approximately 240’ of 8 PVC water main. Contractor will start again tomorrow around 5+75 Line #2.
Misc
Informational
03/16/2021
Contractor completed installation of 8” PVC water on Line #2 and installed approximately 80’ of 8” PVC water main on Line #3 from Sta 1+00 to Sta 0+80 two 11&1/4 bends were used to go behind Tract C parking area. Contractor move to Line #1 to begin installation of 8”PVC water main.
Misc
Informational
03/16/2021
2/24/21 Wednesday Contractor continued to installed 8” PVC water on Line #1 starting with 2-8” gate valve and 8”x8” Tee @ Sta 0+72.59 2/23/21 Tuesday. Contractor should connect to existing 8” water main @ Sta 5+13.33 as per project plans.
Misc
Informational
03/16/2021
2/25/21 Thursday Contractor continued to installed 8” PVC on Line #3 starting at 1+60 to 2+91 as per plan. Contractor also poured straddle blocks on Line # 1 and 3 at near the end of the lines. Fire Hydrant was installed @ Sta 2+89.43 as per project plans.
Misc
Informational
03/16/2021
3/1/21 Monday Contractor excavation existing area for future testing and future tie-ins.
Misc
Informational
03/16/2021
3/2/21 Tuesday Contractor tie-in to the existing 8”x6” tee hydrant that was already installed as permanent. Approximately 66.5’ of 8” water main was installed including MJ fittings. From existing 8”x6” tee 8.5’ to 11 /14 bend 22’ from the 11 1/4 bend to 8”sleeve and 36’ from 8” sleeve to 8”valve.
Misc
Informational
03/16/2021
3/3/21 Wednesday City of Lee’s Summit installed construction tap on newly installed Water Main to perform test.
Misc
Informational
03/16/2021
3/8/21 Monday Chlorination of water line was complete @ 1:00PM.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor ( Beemer - Jim Wolken crew ) preformed tie-in NE Sagamore Dr near the existing Fire Hydrant 008-151FH. Contractor will complete second tie-in at a later date due to the poor ground conditions caused by rainy weather.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor installed 17’ of 8” PVC between two 90 degree and 9’ to the 8’x6’ Tee to the Hydrant Assembly ( This is to be reflect on the As-Built ). Backing block will be poured behind the two 90 deg and 8’x6’ Tee at 1:00PM 3/16/21.
Misc
Informational
03/22/2021
3/22/21 Monday Contractor completed the tie-in of line with a 90 degree bend, backing block for bend will be poured around 11AM.
Sanitary Sewer - Air Test Partial 03/23/2021
Misc
Informational
03/23/2021
3/23/21 Tuesday Contractor began Air test but stopped due to rainy weather conditions. Air test passed from existing manhole on NE Chapel Ridge Place To Manhole A-1.
Sanitary Sewer - Air Test Passed 03/24/2021
Misc
Informational
03/23/2021
3/23/21 Tuesday Contractor began Air test but stopped due to rainy weather conditions. Air test passed from existing manhole on NE Chapel Ridge Place To Manhole A-1.
Misc
Informational
03/24/2021
3/24/21 Wednesday Contractor restarted the air test today. Sanitary Air Test passed from A-1 to A-2 & A-2 to A-3.
Misc
Informational
03/24/2021
3/24/21 Wednesday All of Line B passed sanitary air testing, B4-B3, B3-B2, B2-B1, & B1-Ex MH .
Sanitary Sewer - Vacuum Partial 03/24/2021
Misc
Informational
03/24/2021
3/24/21 Wednesday Vacuum test passed for MH A-1 & A-2
Sanitary Sewer - Mandrel Passed 3/26/2021 3/26/2021 03/26/2021
Misc
Informational
03/26/2021
7.37 inch mandrel passed through all of A and B sanitary lines. RP 3-26-21
Sanitary Sewer - Vacuum Failed 3/26/2021 3/26/2021 03/26/2021
Misc
Informational
03/24/2021
3/24/21 Wednesday Vacuum test passed for MH A-1 & A-2
Misc
Corrective Action Required
03/26/2021
All manholes except for B2 passed their vacuum test. Beemer will be back on Monday to remove casting, cone and rings to find the leak. RP 3-26-21
Sanitary Sewer - Vacuum Passed 3/29/2021 3/29/2021 03/29/2021
Misc
Informational
03/26/2021
3/24/21 Wednesday Vacuum test passed for MH A-1 & A-2
Misc
Corrective Action Required
03/26/2021
All manholes except for B2 passed their vacuum test. Beemer will be back on Monday to remove casting, cone and rings to find the leak. RP 3-26-21
Misc
Informational
03/29/2021
Sanitary manhole B2 passed it’s vacuum test. RP 3-29-21
Master Drainage As-built Inspection Passed 7/1/2021 09/15/2021
Erosion Control Inspection Failed 1/26/2022 1/26/2022 01/26/2022
Misc
Partial Correction
03/18/2021
I will talk with contractor to ensure streets are cleaned up at the end of work day. the forecast of rainy weather will require we stay abreast of the need to frequently clean the streets connected to the site.
Miscellaneous Correction
Corrective Action Required
01/26/2022
1-26-22 AN 1. there is no erosion control in place on the lots being built .. 2. silt fence that is in place needs to be repaired also 3. street needs to be cleaned 4. It front of storm boxes need to be cleaned 5. Trash and old pipes in the field need cleaned up. WE WILL PUT A STOP WORK ORDER ON ALL LOTS IF NOT TAKEN CARE OF ASAP
ADA Inspection Failed 08/10/2022
Miscellaneous Correction
Corrective Action Required
08/10/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
ADA Inspection Partial 08/11/2022
Miscellaneous Correction
Corrective Action Required
08/10/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
Misc
Informational
08/11/2022
8-11-22 AN forms were adjusted to be in spec
ADA Inspection Failed 8/12/2022 8/12/2022 09/15/2022
Miscellaneous Correction
Corrective Action Required
08/11/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
Misc
Informational
08/11/2022
8-11-22 AN forms were adjusted to be in spec
Miscellaneous Correction
Corrective Action Required
09/15/2022
9-15-22 AN 4 of the 5 ADA ramps are out of spec and need to be replaced
ADA Inspection Partial 11/14/2022
Miscellaneous Correction
Corrective Action Required
09/15/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
Misc
Informational
09/15/2022
8-11-22 AN forms were adjusted to be in spec
Miscellaneous Correction
Corrective Action Required
09/15/2022
9-15-22 AN 4 of the 5 ADA ramps are out of spec and need to be replaced 11-14-22 AN concrete crew has Ada ramps re formed up and ready to pure . On one of the ramps we can not get to work and i told them to call there engineer to redesign or relocate the ramp
ADA Inspection Partial 11/15/2022
Miscellaneous Correction
Corrective Action Required
11/14/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
Misc
Informational
11/14/2022
8-11-22 AN forms were adjusted to be in spec
Miscellaneous Correction
Corrective Action Required
11/14/2022
9-15-22 AN 4 of the 5 ADA ramps are out of spec and need to be replaced 11-14-22 AN concrete crew has Ada ramps re formed up and ready to pure . On one of the ramps we can not get to work and i told them to call there engineer to redesign or relocate the ramp 11-15-22 AN. Crew poured some of the ADA ramps to and covered them
ADA Inspection Partial 11/22/2022
Miscellaneous Correction
Corrective Action Required
11/15/2022
8-10-22 AN Forms for the 2 ADA ramps at Sagamore look good But the 2 on Chapel ridge PL are out of spec
Misc
Informational
11/15/2022
8-11-22 AN forms were adjusted to be in spec
Miscellaneous Correction
Corrective Action Required
11/15/2022
9-15-22 AN 4 of the 5 ADA ramps are out of spec and need to be replaced 11-14-22 AN concrete crew has Ada ramps re formed up and ready to pure . On one of the ramps we can not get to work and i told them to call there engineer to redesign or relocate the ramp 11-15-22 AN. Crew poured some of the ADA ramps to and covered them 11-22-22 AN. The 4 ADA ramps that were redone passed and meet ADA spec. Still waiting on one more ramp to be completed
Record Drawing Review Passed 06/02/2023
Erosion Control Inspection Partial 6/9/2023 06/09/2023
Misc
Partial Correction
01/26/2022
I will talk with contractor to ensure streets are cleaned up at the end of work day. the forecast of rainy weather will require we stay abreast of the need to frequently clean the streets connected to the site.
Miscellaneous Correction
Corrective Action Required
01/26/2022
1-26-22 AN 1. there is no erosion control in place on the lots being built .. 2. silt fence that is in place needs to be repaired also 3. street needs to be cleaned 4. It front of storm boxes need to be cleaned 5. Trash and old pipes in the field need cleaned up. WE WILL PUT A STOP WORK ORDER ON ALL LOTS IF NOT TAKEN CARE OF ASAP
Misc
Informational
06/09/2023
6-9-23 NS No erosion control issues
Documents & Images
Date Uploaded File Type Document Name
07/29/2020 Townhomes at Chapel Ridge Water 6-16-2020 Approved 7.29.20
07/29/2020 Townhomes of Chapel Ridge Sanitary 6-4-2020 Approved 7.29.20
07/29/2020 Receipt Receipt for transaction:2020-004824
07/29/2020 Letter DE-Permit
07/30/2020 Approved Plans Townhomes of Chapel Ridge Street and Storm Plans Approved 7_30_20
07/31/2020 Letter INSPECTION SUMMARY
08/03/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/18/2020 Letter INSPECTION SUMMARY
08/20/2020 Letter INSPECTION SUMMARY
08/21/2020 Letter INSPECTION SUMMARY
09/03/2020 image.jpg
09/03/2020 Letter INSPECTION SUMMARY
09/03/2020 Letter INSPECTION SUMMARY
09/04/2020 Letter INSPECTION SUMMARY
09/04/2020 Letter INSPECTION SUMMARY
09/09/2020 Letter INSPECTION SUMMARY
09/09/2020 image.jpg0
09/09/2020 image.jpg1
09/09/2020 image.jpg2
09/15/2020 Letter INSPECTION SUMMARY
09/16/2020 Letter INSPECTION SUMMARY
09/17/2020 Letter INSPECTION SUMMARY
09/21/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/30/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/02/2020 Letter INSPECTION SUMMARY
10/05/2020 Letter INSPECTION SUMMARY
10/05/2020 Letter INSPECTION SUMMARY
10/07/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/09/2020 image.jpg3
10/09/2020 image.jpg4
10/09/2020 Letter INSPECTION SUMMARY
10/12/2020 image.jpg5
10/12/2020 image.jpg6
10/12/2020 image.jpg7
10/12/2020 Letter INSPECTION SUMMARY
10/12/2020 Letter INSPECTION SUMMARY
10/12/2020 Letter INSPECTION SUMMARY
10/12/2020 Letter INSPECTION SUMMARY
10/13/2020 Letter INSPECTION SUMMARY
10/14/2020 Letter INSPECTION SUMMARY
10/15/2020 image.jpg8
10/15/2020 Letter INSPECTION SUMMARY
10/15/2020 Letter INSPECTION SUMMARY
10/15/2020 image.jpg9
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/30/2020 Letter INSPECTION SUMMARY
10/30/2020 Letter INSPECTION SUMMARY
10/31/2020 Letter INSPECTION SUMMARY
11/11/2020 Letter INSPECTION SUMMARY
11/11/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/20/2020 image.jpg11
11/20/2020 Letter INSPECTION SUMMARY
11/30/2020 image.jpg12
11/30/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
10/28/2020 Letter INSPECTION SUMMARY
12/09/2020 image.jpg15
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 image.jpg16
12/09/2020 Letter INSPECTION SUMMARY
10/27/2020 Letter INSPECTION SUMMARY
10/23/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
12/10/2020 image.jpg17
12/10/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/06/2020 Letter INSPECTION SUMMARY
09/18/2020 Letter INSPECTION SUMMARY
09/09/2020 Letter INSPECTION SUMMARY
09/09/2020 Letter INSPECTION SUMMARY
09/03/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
08/17/2020 Letter INSPECTION SUMMARY
01/28/2021 image.jpg26
01/28/2021 image.jpg27
01/28/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/25/2021 Letter INSPECTION SUMMARY
02/25/2021 Letter INSPECTION SUMMARY
03/01/2021 Letter INSPECTION SUMMARY
03/02/2021 Letter INSPECTION SUMMARY
03/02/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
07/27/2020 Receipt Receipt for transaction:2020-004705
03/10/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY
12/08/2020 Letter INSPECTION SUMMARY
12/08/2020 Letter INSPECTION SUMMARY
12/08/2020 Letter INSPECTION SUMMARY
12/08/2020 image.jpg14
03/23/2021 Letter INSPECTION SUMMARY
03/24/2021 Letter INSPECTION SUMMARY
12/08/2020 Letter INSPECTION SUMMARY
12/05/2020 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/29/2021 Letter INSPECTION SUMMARY
12/05/2020 image.jpg13
08/18/2021 Plans WATER 8-18-2021
08/18/2021 Plans SANITARY 8-18-2021
08/18/2021 Plans MASTER DRAINAGE PLAN 8-18-2021
08/18/2021 Plans STREET AND STORM 8-18-2021
11/19/2020 Letter INSPECTION SUMMARY
09/09/2021 Plans MDP 9-9-2021 The Townshomes of Chapel Ridge, 2nd Plat
09/15/2021 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/19/2020 image.jpg10
10/21/2021 Security Document Asphalt Bond
11/12/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
02/07/2022 Activity Document Signed Punch List
12/10/2020 Letter INSPECTION SUMMARY
03/22/2022 Security Document Townhomes at Chapel Ridge 2nd Plat Maintenance Bond
01/21/2021 image.jpg18
08/11/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
10/11/2022 Security Document Chapel Ridge Townhomes 2nd Plat - Water, Sanitary and Storm Maintenance Bond
01/21/2021 image.jpg19
11/15/2022 Letter INSPECTION SUMMARY
01/21/2021 image.jpg20
02/29/2024 Letter DE-Certificate of Final Acceptance (Commercial)
01/21/2021 image.jpg21
05/28/2024 Email Bond Inspection has Passed
01/21/2021 image.jpg22
01/21/2021 image.jpg23
01/21/2021 image.jpg24
01/21/2021 image.jpg25
01/21/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
03/22/2021 image.jpg28
03/22/2021 Letter INSPECTION SUMMARY
03/22/2021 Letter INSPECTION SUMMARY
03/24/2021 Letter INSPECTION SUMMARY
03/18/2021 Letter INSPECTION SUMMARY
03/24/2021 Letter INSPECTION SUMMARY
06/28/2021 Plans MASTER DRAINAGE PLAN ASBUILTS
09/01/2021 Letter INSPECTION SUMMARY
09/20/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
09/20/2021 Letter DE-Punch List
01/27/2022 Letter INSPECTION SUMMARY
01/26/2022 Letter INSPECTION SUMMARY
01/26/2022 Letter INSPECTION SUMMARY
08/10/2022 Letter INSPECTION SUMMARY
02/07/2022 Letter Townhomes at Chappel Ridge 2nd Plat Final Punch List
11/14/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
05/28/2024 Letter PW ROW Inspections Report
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
