Summary


PRSUBD20202008
Public Infrastructure
Final Acceptance
CLAYTON PROPERTIES GROUP INC
DEVELOPMENT COMPLETE
Woodside Ridge 2nd Plat - Full subdivision development
07/21/2020
02/22/2021
08/07/2023
Locations
Address
2058 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2062 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2066 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2070 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2074 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2078 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2082 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2086 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2090 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2094 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2098 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2100 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
361 NW PATCH CT, LEES SUMMIT, MO 64081

Address
365 NW PATCH CT, LEES SUMMIT, MO 64081

Address
369 NW PATCH CT, LEES SUMMIT, MO 64081

Address
373 NW PATCH CT, LEES SUMMIT, MO 64081

Address
377 NW PATCH CT, LEES SUMMIT, MO 64081

Address
374 NW PATCH CT, LEES SUMMIT, MO 64081

Address
370 NW PATCH CT, LEES SUMMIT, MO 64081

Address
366 NW PATCH CT, LEES SUMMIT, MO 64081

Address
362 NW PATCH CT, LEES SUMMIT, MO 64081

Address
2116 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2125 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2121 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2117 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2113 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2109 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2105 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2055 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2059 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2063 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2067 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2071 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2075 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2079 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2083 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2087 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2091 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2095 NW OBRIEN RD, LEES SUMMIT, MO 64081

Address
2206 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2210 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2214 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2218 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2222 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2226 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2230 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2234 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2238 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2241 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2237 NW SUMMERFIELD DR, LEES SUMMIT, MO 64081

Address
2233 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2229 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2225 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2221 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2217 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Address
2213 NW KILLARNEY LN, LEES SUMMIT, MO 64081

Property
62210113400000000

Property
62210113500000000

Property
62210113600000000

Property
62210113700000000

Property
62210113800000000

Property
62210113900000000

Property
62210114000000000

Property
62210114100000000

Property
62210114200000000

Property
62210114300000000

Property
62210114400000000

Property
62210115700000000

Property
62210114500000000

Property
62210114600000000

Property
62210114700000000

Property
62210114800000000

Property
62210114900000000

Property
62210115000000000

Property
62210115100000000

Property
62210115200000000

Property
62210115300000000

Property
62210115400000000

Property
62240221400000000

Property
62240221500000000

Property
62240221600000000

Property
62240221700000000

Property
62240221800000000

Property
62240221900000000

Property
62210120200000000

Property
62210120300000000

Property
62210120400000000

Property
62210120500000000

Property
62210120600000000

Property
62210120700000000

Property
62210120800000000

Property
62210120900000000

Property
62210121000000000

Property
62210121100000000

Property
62210121200000000

Property
62240220600000000

Property
62240220700000000

Property
62240220800000000

Property
62240220900000000

Property
62240231300000000

Property
62240221000000000

Property
62240221100000000

Property
62240221200000000

Property
62240221300000000

Property
62210115700000000

Property
51830042300000000

Property
62240231500000000

Property
62240231600000000

Property
62240231700000000

Property
62240231800000000

Property
62240231900000000

Property
62240232000000000

Address
2120 NW OBRIEN RD, LEES SUMMIT, MO 64081

Property
62210115800000000

Contacts
CLAYTON PROPERTIES GROUP INC, Address:120 SE 30TH ST
CLAYTON PROPERTIES GROUP, INC, Address:120 SE 30TH ST, Phone:(816) 246-6700
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
LARRY CANNON, Address:EMERY SAPP & SONS, Phone:(573) 489-9224
FROEHLICH CONSTRUCTION LLC, Address:209 SW LEWIS CT
GENTLES MICHAEL B & ASHLEIGH D, Address:2062 NW O'BRIEN RD
TRUMARK CUSTOM HOMES LLC, Address:2924 NW THOREAU DR
WOODSIDE RIDGE MASTER HOMES ASSOCIATION INC, Address:10660 BARKLEY ST
FROEHLICH CONSTRUCTION LLC, Address:406 NW DONOVAN RD
SMITH STEPHEN & BECKY JOHNSON, Address:365 NW PATCH CT
JFE CONSTRUCTION INC, Address:1314 SW MARKET ST
JEF CONSTRUCTION INC, Address:1314 SW MARKET ST
STAIHR MIKE & KATHY, Address:374 NW PATCH CT
NYQUIST HANS JEROME & MIRANDA SHAY, Address:370 NW PATCH CT
NEW MARK HOMES-KC LLC, Address:5207 NW CROOKED RD
LOVINS TROY & SARA, Address:362 NW PATCH CT
WATT TYLER & SIERRA, Address:2125 NW OBRIEN RD
BAUER MICHAEL P & KATHERINE A, Address:2121 NW OBRIEN RD
COCHRAN MARINA C & MICKEY J, Address:2113 NW OBRIEN RD
MURRELL KEITH L, Address:2109 NW OBRIEN RD
BACON BRANDON TODD & MEG, Address:2105 NW OBRIEN RD
RAHM JASON & MICHELLE, Address:2055 NW OBRIEN RD
BAXTER ETHAN & CHELSEA, Address:2059 NW OBRIEN RD
PAULY RYAN & CHRISTY LYNNE, Address:2063 NW OBRIEN RD
COBBINS OTIS L & CHRISTINA J, Address:2067 NW OBRIEN RD
O'BRIEN FRANK MICHAEL AND KAITLIN JULY, Address:2071 NW OBRIEN RD
EVANS FAMILY TRUST DATED 01/30/2007, Address:2075 NW OBRIEN RD
VEGTER TRAVIS JAMES & ABIGAIL JO, Address:2079 NW OBRIEN RD
RAWSON DAN & MELISSA, Address:2083 NW OBRIEN RD
KLOSSEN SCOTT A, Address:2091 NW OBRIEN RD
MIESER RICHARD KEITH JR & STACY LYNN, Address:2095 NW OBRIEN RD
PFEIFER HOMES INC, Address:1550 SW MARKET ST
COX ANITA MARIE, Address:2210 NW KILLARNEY LN
PFEIFER HOMES INC, Address:1550 SW MARKET ST STE 210
WOODSIDE RIDGE MASTER HOMES ASSOCIATION INC, Address:10660 BARKLEY ST
STODDARD ROBERT B, Address:2226 NW KILLARNEY LN
BURMEISTER FAMILY TRUST AGREEMENT DATE 03/31/1998, Address:2230 NW KILLARNEY LN
WILLIAMS NED & ROSE M, Address:2237 NW SUMMERFIELD DR
CLIFFORD LIVING TRUST DATED 08/03/2023, Address:2233 NW KILLARNEY LN
MOORE DAVID & SHERWYN, Address:2221 NW KILLARNEY LN
NEWMAN LEGACY WEALTH TRUST DATED 03/05/2013, Address:2217 NW KILLARNEY LN
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 07/21/2020 02/18/2021
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
Water Insp Fee $4,495.86 $4,495.86 Paid 02/18/2021
Water Test Fee $1,600.00 $1,600.00 Paid 02/18/2021
Sanitary Sewer Insp Fees $7,521.41 $7,521.41 Paid 02/18/2021
Right of Way Permit Fee $80.00 $80.00 Paid 02/18/2021
Storm Sewer Inspection Fee $5,592.49 $5,592.49 Paid 02/18/2021
Paved Surface Inspection Fee $9,885.58 $9,885.58 Paid 02/18/2021
Site Grading Fee $17,077.44 $17,077.44 Paid 02/18/2021
After Hours Inspections (Public Works)(Per Hour) $150.00 $150.00 Paid 01/21/2022
After Hours Inspections (Public Works)(Per Hour) $75.00 $75.00 Paid 01/21/2022
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 01/21/2022
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 01/21/2022
After Hours Inspections (Public Works)(Per Hour) $25.00 $25.00 Paid 01/21/2022
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 01/21/2022
Outstanding Fees Amount Paid Owing Date Paid


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 5/25/2021 5/25/2021 05/25/2021
Misc
Informational
05/25/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Site Visit Partial 6/4/2021 6/4/2021 06/04/2021
Misc
Informational
05/25/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Site Visit Partial 6/7/2021 6/7/2021 06/09/2021
Misc
Informational
06/04/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/04/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/09/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Sanitary Sewer Construction Inspection Partial 7/2/2021 7/2/2021 07/05/2021
Misc
Informational
07/05/2021
ESS bored into existing manhole 28-364. RP 6-22-21
Misc
Informational
07/05/2021
ESS constructed the manhole drop and back filled it with concrete. RP 6-23-21
Misc
Informational
07/05/2021
They laid 4 sticks of sanitary pipe. RP 6-25-21
Misc
Informational
07/05/2021
They laid another 5 sticks of sanitary pipe. RP 6-28-21
Misc
Informational
07/05/2021
They laid 4 sticks of sanitary pipe. RP 7-2-21
Misc
Informational
07/05/2021
They set the base for manhole 1-1. Wrong barrel section on site, so they had to stop there today. RP 7-5-21
Sanitary Sewer Construction Inspection Partial 7/7/2021 7/7/2021 07/08/2021
Misc
Informational
07/08/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Sanitary Sewer Construction Inspection Partial 7/8/2021 7/8/2021 07/08/2021
Misc
Informational
07/08/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/08/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Sanitary Sewer Construction Inspection Partial 7/9/2021 7/9/2021 07/09/2021
Misc
Informational
07/08/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/08/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/09/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Sanitary Sewer Construction Inspection Partial 7/12/2021 7/12/2021 07/12/2021
Misc
Informational
07/09/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/09/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/09/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/12/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Site Visit Partial 7/12/2021 7/12/2021 07/12/2021
Misc
Informational
06/09/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
06/09/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/09/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/09/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/09/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
07/12/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Sanitary Sewer Construction Inspection Partial 7/13/2021 7/13/2021 07/13/2021
Misc
Informational
07/12/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/12/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/12/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/12/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/13/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Sanitary Sewer Construction Inspection Partial 7/14/2021 7/14/2021 07/16/2021
Misc
Informational
07/13/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/13/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/13/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/13/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/13/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/15/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/16/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/16/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Sanitary Sewer Construction Inspection Partial 7/19/2021 7/19/2021 07/19/2021
Misc
Informational
07/16/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/16/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/16/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/16/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/16/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/16/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/16/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/16/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/19/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Sanitary Sewer Construction Inspection Partial 7/20/2021 07/20/2021
Misc
Informational
07/19/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/19/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/19/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/19/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/19/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/19/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/19/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/19/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/19/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/20/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Sanitary Sewer Construction Inspection Partial 7/21/2021 7/21/2021 07/21/2021
Misc
Informational
07/20/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/20/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/20/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/20/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/20/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/20/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/20/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/20/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/20/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/20/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/21/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Sanitary Sewer Construction Inspection Partial 7/22/2021 7/22/2021 07/22/2021
Misc
Informational
07/21/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/21/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/21/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/21/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/21/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/21/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/21/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/21/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/21/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/21/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/21/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/22/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Sanitary Sewer Construction Inspection Partial 7/23/2021 7/23/2021 07/23/2021
Misc
Informational
07/22/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/22/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/22/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/22/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/22/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/22/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/22/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/22/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/22/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/22/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/22/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/22/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/23/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Sanitary Sewer Construction Inspection Partial 7/26/2021 7/26/2021 07/26/2021
Misc
Informational
07/23/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/23/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/23/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/23/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/23/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/23/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/23/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/23/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/23/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/23/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/23/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/23/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/23/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/26/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Sanitary Sewer Construction Inspection Partial 7/27/2021 7/27/2021 07/27/2021
Misc
Informational
07/26/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/26/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/26/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/26/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/26/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/26/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/26/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/26/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/26/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/26/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/26/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/26/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/26/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/26/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
07/27/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Sanitary Sewer Construction Inspection Partial 7/28/2021 7/28/2021 07/28/2021
Misc
Informational
07/27/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/27/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/27/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/27/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/27/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/27/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/27/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/27/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/27/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/27/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/27/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/27/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/27/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/27/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
07/27/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
07/28/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Sanitary Sewer Construction Inspection Partial 7/29/2021 7/29/2021 07/30/2021
Misc
Informational
07/28/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/28/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/28/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/28/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/28/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/28/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/28/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/28/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/28/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/28/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/28/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/28/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/28/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/28/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
07/28/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
07/28/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
07/30/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Sanitary Sewer Construction Inspection Partial 7/30/2021 7/30/2021 07/30/2021
Misc
Informational
07/30/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/30/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/30/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/30/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/30/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/30/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/30/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/30/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/30/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/30/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/30/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/30/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/30/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/30/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
07/30/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
07/30/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
07/30/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
07/30/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Sanitary Sewer Construction Inspection Partial 8/2/2021 8/2/2021 08/02/2021
Misc
Informational
07/30/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
07/30/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
07/30/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
07/30/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
07/30/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
07/30/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/30/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
07/30/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
07/30/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
07/30/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
07/30/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
07/30/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
07/30/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
07/30/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
07/30/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
07/30/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
07/30/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
07/30/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/02/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Sanitary Sewer Construction Inspection Partial 8/3/2021 8/3/2021 08/03/2021
Misc
Informational
08/02/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/02/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/02/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/02/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/02/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/02/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/02/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/02/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/02/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/02/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/02/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/02/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/02/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/02/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/02/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/02/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/02/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/02/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/02/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/03/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Sanitary Sewer Construction Inspection Partial 8/4/2021 8/4/2021 08/04/2021
Misc
Informational
08/03/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/03/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/03/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/03/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/03/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/03/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/03/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/03/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/03/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/03/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/03/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/03/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/03/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/03/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/03/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/03/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/03/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/03/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/03/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/03/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/04/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Sanitary Sewer Construction Inspection Partial 8/5/2021 8/5/2021 08/05/2021
Misc
Informational
08/04/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/04/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/04/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/04/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/04/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/04/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/04/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/04/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/04/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/04/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/04/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/04/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/04/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/04/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/04/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/04/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/04/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/04/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/04/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/04/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/04/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/05/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Sanitary Sewer Construction Inspection Partial 8/6/2021 8/6/2021 08/06/2021
Misc
Informational
08/05/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/05/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/05/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/05/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/05/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/05/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/05/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/05/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/05/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/05/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/05/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/05/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/05/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/05/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/05/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/05/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/05/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/05/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/05/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/05/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/05/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/05/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/06/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Sanitary Sewer Construction Inspection Partial 8/9/2021 8/9/2021 08/09/2021
Misc
Informational
08/06/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/06/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/06/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/06/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/06/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/06/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/06/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/06/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/06/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/06/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/06/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/06/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/06/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/06/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/06/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/06/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/06/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/06/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/06/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/06/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/06/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/06/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/06/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/09/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Sanitary Sewer Construction Inspection Partial 8/11/2021 8/11/2021 08/11/2021
Misc
Informational
08/09/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/09/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/09/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/09/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/09/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/09/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/09/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/09/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/09/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/09/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/09/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/09/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/09/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/09/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/09/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/09/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/09/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/09/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/09/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/09/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/09/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/09/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/09/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/09/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/11/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Sanitary Sewer Construction Inspection Partial 8/12/2021 8/12/2021 08/12/2021
Misc
Informational
08/11/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/11/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/11/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/11/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/11/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/11/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/11/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/11/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/11/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/11/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/11/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/11/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/11/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/11/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/11/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/11/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/11/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/11/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/11/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/11/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/11/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/11/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/11/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/11/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/11/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/12/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Sanitary Sewer Construction Inspection Partial 8/16/2021 8/16/2021 08/16/2021
Misc
Informational
08/12/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/12/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/12/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/12/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/12/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/12/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/12/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/12/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/12/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/12/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/12/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/12/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/12/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/12/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/12/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/12/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/12/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/12/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/12/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/12/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/12/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/12/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/12/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/12/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/12/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/12/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/16/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Sanitary Sewer Construction Inspection Partial 8/17/2021 8/17/2021 08/17/2021
Misc
Informational
08/16/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/16/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/16/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/16/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/16/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/16/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/16/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/16/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/16/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/16/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/16/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/16/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/16/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/16/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/16/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/16/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/16/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/16/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/16/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/16/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/16/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/16/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/16/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/16/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/16/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/16/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/16/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Misc
Informational
08/17/2021
Steve’s crew raised the 2 existing manholes and started pre-testing the sanitary lines. The 30 day clock starts today. RP 8-17-21
Sanitary Sewer Construction Inspection Partial 8/18/2021 8/18/2021 08/18/2021
Misc
Informational
08/17/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/17/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/17/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/17/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/17/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/17/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/17/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/17/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/17/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/17/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/17/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/17/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/17/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/17/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/17/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/17/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/17/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/17/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/17/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/17/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/17/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/17/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/17/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/17/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/17/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/17/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/17/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Misc
Informational
08/17/2021
Steve’s crew raised the 2 existing manholes and started pre-testing the sanitary lines. The 30 day clock starts today. RP 8-17-21
Misc
Informational
08/18/2021
They continued to pre test the sanitary lines (mandrel, air and vacuum). RP 8-18-21
Sanitary Sewer Construction Inspection Partial 8/19/2021 8/19/2021 08/19/2021
Misc
Informational
08/18/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/18/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/18/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/18/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/18/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/18/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/18/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/18/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/18/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/18/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/18/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/18/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/18/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/18/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/18/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/18/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/18/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/18/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/18/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/18/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/18/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/18/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/18/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/18/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/18/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/18/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/18/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Misc
Informational
08/18/2021
Steve’s crew raised the 2 existing manholes and started pre-testing the sanitary lines. The 30 day clock starts today. RP 8-17-21
Misc
Informational
08/18/2021
They continued to pre test the sanitary lines (mandrel, air and vacuum). RP 8-18-21
Misc
Informational
08/19/2021
More pre-testing the sanitary lines. Looking for a leak in sanitary line 3. RP 8-19-21
Sanitary Sewer Construction Inspection Partial 8/20/2021 8/20/2021 08/20/2021
Misc
Informational
08/19/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/19/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/19/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/19/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/19/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/19/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/19/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/19/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/19/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/19/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/19/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/19/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/19/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/19/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/19/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/19/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/19/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/19/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/19/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/19/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/19/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/19/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/19/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/19/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/19/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/19/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/19/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Misc
Informational
08/19/2021
Steve’s crew raised the 2 existing manholes and started pre-testing the sanitary lines. The 30 day clock starts today. RP 8-17-21
Misc
Informational
08/19/2021
They continued to pre test the sanitary lines (mandrel, air and vacuum). RP 8-18-21
Misc
Informational
08/19/2021
More pre-testing the sanitary lines. Looking for a leak in sanitary line 3. RP 8-19-21
Misc
Informational
08/20/2021
They found and repaired the leak on line 3. No other problems during the pre-testing. Now we are just waiting for the 30 days to expire for the actual testing. RP 8-20-21
Storm Sewer Construction Inspection Partial 8/23/2021 8/23/2021 08/23/2021
Misc
Informational
08/23/2021
They laid 80 feet of 15 inch HDPE storm pipe from ES 4-1 towards MH 4-2. Having to break a lot of rock on this line. RP 8-23-21.
Storm Sewer Construction Inspection Partial 8/24/2021 8/24/2021 08/24/2021
Misc
Informational
08/24/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Storm Sewer Construction Inspection Partial 8/25/2021 8/25/2021 08/25/2021
Misc
Informational
08/24/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
08/25/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Storm Sewer Construction Inspection Partial 8/26/2021 8/26/2021 08/26/2021
Misc
Informational
08/25/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
08/25/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
08/26/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Storm Sewer Construction Inspection Partial 8/27/2021 8/27/2021 08/27/2021
Misc
Informational
08/26/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
08/26/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
08/26/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
08/27/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Storm Sewer Construction Inspection Partial 8/30/2021 8/30/2021 08/31/2021
Misc
Informational
08/27/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
08/27/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
08/27/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
08/27/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
08/31/2021
Crew was rained out today. RP 8-31-21
Storm Sewer Construction Inspection Partial 9/1/2021 9/1/2021 09/01/2021
Misc
Informational
08/31/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
08/31/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
08/31/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
08/31/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
08/31/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/01/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Storm Sewer Construction Inspection Partial 9/2/2021 9/2/2021 09/02/2021
Misc
Informational
09/01/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/01/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/01/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/01/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/01/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/01/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/02/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Storm Sewer Construction Inspection Partial 9/3/2021 9/3/2021 09/03/2021
Misc
Informational
09/02/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/02/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/02/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/02/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/02/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/02/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/02/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/03/2021
Storms caused a rain out today. RP 9-3-21
Storm Sewer Construction Inspection Partial 9/7/2021 9/7/2021 09/07/2021
Misc
Informational
09/03/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/03/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/03/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/03/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/03/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/03/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/03/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/03/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/07/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Storm Sewer Construction Inspection Partial 9/8/2021 9/8/2021 09/08/2021
Misc
Informational
09/07/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/07/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/07/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/07/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/07/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/07/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/07/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/07/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/07/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/08/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Storm Sewer Construction Inspection Partial 9/9/2021 9/9/2021 09/09/2021
Misc
Informational
09/08/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/08/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/08/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/08/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/08/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/08/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/08/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/08/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/08/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/08/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/09/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Storm Sewer Construction Inspection Partial 9/10/2021 9/10/2021 09/10/2021
Misc
Informational
09/09/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/09/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/09/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/09/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/09/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/09/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/09/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/09/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/09/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/09/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/09/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Misc
Informational
09/10/2021
They laid 300 feet of 15 inch HDPE storm pipe and set curb inlet 6-1. They also poured collars and inverts. RP 9-10-21
Storm Sewer Construction Inspection Partial 9/11/2021 9/11/2021 09/11/2021
Misc
Informational
09/10/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/10/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/10/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/10/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/10/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/10/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/10/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/10/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/10/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/10/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/10/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Misc
Informational
09/10/2021
They laid 300 feet of 15 inch HDPE storm pipe and set curb inlet 6-1. They also poured collars and inverts. RP 9-10-21
Misc
Informational
09/11/2021
They laid 70 feet of 15 inch and 35 feet of 18 inch HDPE storm pipe and set curb inlets 2-5, 6-2 and 7-5. They also poured collars and inverts, then back filled and cleaned up for the weekend. RP 9-11-21
Storm Sewer Construction Inspection Partial 9/15/2021 9/15/2021 09/15/2021
Misc
Informational
09/11/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/11/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/11/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/11/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/11/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/11/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/11/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/11/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/11/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/11/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/11/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Misc
Informational
09/11/2021
They laid 300 feet of 15 inch HDPE storm pipe and set curb inlet 6-1. They also poured collars and inverts. RP 9-10-21
Misc
Informational
09/11/2021
They laid 70 feet of 15 inch and 35 feet of 18 inch HDPE storm pipe and set curb inlets 2-5, 6-2 and 7-5. They also poured collars and inverts, then back filled and cleaned up for the weekend. RP 9-11-21
Misc
Informational
09/15/2021
They’ve been breaking rock for line 3 for 2 days now. RP 9-15-21
Storm Sewer Construction Inspection Partial 9/17/2021 9/17/2021 09/17/2021
Misc
Informational
09/15/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/15/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/15/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/15/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/15/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/15/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/15/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/15/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/15/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/15/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/15/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Misc
Informational
09/15/2021
They laid 300 feet of 15 inch HDPE storm pipe and set curb inlet 6-1. They also poured collars and inverts. RP 9-10-21
Misc
Informational
09/15/2021
They laid 70 feet of 15 inch and 35 feet of 18 inch HDPE storm pipe and set curb inlets 2-5, 6-2 and 7-5. They also poured collars and inverts, then back filled and cleaned up for the weekend. RP 9-11-21
Misc
Informational
09/15/2021
They’ve been breaking rock for line 3 for 2 days now. RP 9-15-21
Misc
Informational
09/17/2021
They laid 250 feet of 18 inch HDPE storm pipe and set curb inlet 3-3 and storm manhole 3-2. They also poured collars and inverts on all structures. RP 9-17-21
Site Visit Partial 7/13/2021 7/13/2021 09/21/2021
Misc
Informational
07/12/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
07/12/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
07/12/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
07/12/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
07/12/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
07/12/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
09/21/2021
No work going on today due to the rain overnight.
Sanitary Sewer - Mandrel Partial 9/24/2021 9/24/2021 09/24/2021
Misc
Informational
09/24/2021
9-24-21 11:00 AN. Began Mandrel test at 9:30 and stoped at 11:00 because contractors poured the concrete inverts wrong not allowing the mandrel to enter the 8” pipe. Inverts need to be fixed. Andrew is going to call and reschedule.
Sanitary Sewer - Mandrel Failed 9/27/2021 9/27/2021 09/27/2021
Misc
Informational
09/24/2021
9-24-21 11:00 AN. Began Mandrel test at 9:30 and stoped at 11:00 because contractors poured the concrete inverts wrong not allowing the mandrel to enter the 8” pipe. Inverts need to be fixed. Andrew is going to call and reschedule.
Misc
Corrective Action Required
09/27/2021
All mandrel test passed EXCEPT between MH 4-4 and M4-3 . Mandrel got stuck around 14ft from MH 4-3 FAILED
Sanitary Sewer - Vacuum Failed 9/29/2021 9/29/2021 09/29/2021
Misc
Corrective Action Required
09/29/2021
9-27-21 8:00 AN Vacuum test 10psi for 3.5 min MH 9-4 passed. MH 4-5 passed MH 3-1 passed. MH 4-4 passed MH 3-2 fixed and passed. MH 4-3 passed MH 3-3 passed. MH 4-2 passed MH 1-6 passed. MH 4-1 FAILED MH 1-5 passed MH 1-4 passed MH 1-3 passed MH 1-2 passed MH 1-1 passed MH 2-3 passed MH 2-2 passed MH 2-1 passed
Sanitary Sewer - Air Test Failed 9/29/2021 9/29/2021 09/29/2021
Misc
Corrective Action Required
09/29/2021
9-27-21 8:00 AN Pressure test 4psi between 10min and 7:30min MH 9-4 to 3-1 passed. MH 2-2 to 2-1 passed MH 3-1 to 3-2 passed. MH 2-1 to 1-2 passed MH 3-2 to 3-3 passed. MH 2-3 to 2-2 passed MH 1-6 to 1-5 passed. MH 4-5 to 4-4 passed MH 1-5 to 1-4 passed. MH 4-4 to 4-3 FAILED start for 30days is 9-27-21 MH 1-4 to 1-3 passed. MH 4-3 to 4-2 passed MH 1-3 to 1-2 passed. MH 4-2 to 4-1 passed MH 1-2 to 1-1 passed. MH 4-1 to EX MH 2 passed MH 1-1 to 1-0 passed
Site Visit Partial 10/1/2021 10/1/2021 10/01/2021
Misc
Informational
09/21/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
09/21/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
09/21/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
09/21/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
09/21/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
09/21/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
09/21/2021
No work going on today due to the rain overnight.
Misc
Informational
10/01/2021
ESS is cutting roadways down to grade. RP 10-1-21
Pavement-Stabilized Subgrade Partial 10/04/2021
Misc
Informational
10/04/2021
Seal o Matic is instilling in Portland cement on O’Brien and Killarney. They have 2 passes left on O’Brien and they will be done. Testing company was here and said They were good on moisture and Portland. Testing company will send results over.
Misc
Informational
10/06/2021
Mo-type 5 is being dropped off and installed today.
Sanitary Sewer - Vacuum Passed 10/5/2021 10/5/2021 10/05/2021
Misc
Informational
10/05/2021
9-27-21 8:00 AN Vacuum test 10psi for 3.5 min MH 9-4 passed. MH 4-5 passed MH 3-1 passed. MH 4-4 passed MH 3-2 fixed and passed. MH 4-3 passed MH 3-3 passed. MH 4-2 passed MH 1-6 passed. MH 4-1 FAILED MH 1-5 passed MH 1-4 passed MH 1-3 passed MH 1-2 passed MH 1-1 passed MH 2-3 passed MH 2-2 passed MH 2-1 passed
Misc
Informational
10/05/2021
MH 4-1 fixed and passed
Pavement-Proof Roll Partial 10/06/2021
Misc
Informational
10/06/2021
Proof roll passed except for one 10ft. Area by O’Brien. Installed a stretch of geo grid and added 6 “ of type 5 rock. Trucks ran over it this morning and it was good to go , This proof roll was for chemical subgrade, will still need one for the rock.
Pavement-Proof Roll Partial 10/18/2021 10/18/2021 10/18/2021
Misc
Informational
10/06/2021
Proof roll passed except for one 10ft. Area by O’Brien. Installed a stretch of geo grid and added 6 “ of type 5 rock. Trucks ran over it this morning and it was good to go , This proof roll was for chemical subgrade, will still need one for the rock.
Misc
Informational
10/18/2021
They had a tandem dump truck with a 21.3 ton load. Proof rolled just the curb line. Everything passed except for 2 storm boxes on O’Brien. They will make adjustments and reroll this area next week. RP 10-18-21
Pavement-Curb Construction Partial 10/18/2021 10/18/2021 10/19/2021
Misc
Informational
10/19/2021
ESS poured 120 cubic yards of 4K KCMMB mix for curbing. KC testing was on site doing sampling. RP 10-18-21
Pavement-Curb Construction Partial 10/19/2021 10/19/2021 10/19/2021
Misc
Informational
10/19/2021
ESS poured another 106 cubic yards of 4K KCMMB mix. RP 10-19-21
Pavement-Curb Construction Partial 10/20/2021 10/20/2021 10/20/2021
Misc
Informational
10/19/2021
ESS poured another 106 cubic yards of 4K KCMMB mix. RP 10-19-21
Misc
Informational
10/20/2021
They hand framed and poured 20 cubic yards of 4K KCMMB mix for storm inlets. RP 10-20-21
Pavement-Curb Construction Partial 10/21/2021 10/21/2021 10/21/2021
Misc
Informational
10/20/2021
ESS poured another 106 cubic yards of 4K KCMMB mix. RP 10-19-21
Misc
Informational
10/20/2021
They hand framed and poured 20 cubic yards of 4K KCMMB mix for storm inlets. RP 10-20-21
Misc
Informational
10/21/2021
Contractor finished pouring small sections of curb on O’Brien and working on finishing inlet box curbing and curb sections on Killarney. Noticed multiple manholes were in the process of being or needing to be raised. Need to verify they are wrapped after raising. 10/21 ES
Sanitary Sewer - Mandrel Passed 10/27/2021
Misc
Informational
09/27/2021
9-24-21 11:00 AN. Began Mandrel test at 9:30 and stoped at 11:00 because contractors poured the concrete inverts wrong not allowing the mandrel to enter the 8” pipe. Inverts need to be fixed. Andrew is going to call and reschedule.
Misc
Resolved
10/27/2021
All mandrel test passed EXCEPT between MH 4-4 and M4-3 . Mandrel got stuck around 14ft from MH 4-3 FAILED
Misc
Informational
10/27/2021
10-27-21 12:30 AN sewer line was repaired on sep 26th. We reran the mandrel test on oct 27th and it PASSED between MH 4-4 and M4-3. All mandrel test are complete and PASSED
Site Visit Partial 11/2/2021 11/2/2021 11/02/2021
Misc
Informational
10/01/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
10/01/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
10/01/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
10/01/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
10/01/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
10/01/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
10/01/2021
No work going on today due to the rain overnight.
Misc
Informational
10/01/2021
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
11/02/2021
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Pavement-Proof Roll Passed 11/2/2021 11/2/2021 11/02/2021
Misc
Informational
10/18/2021
Proof roll passed except for one 10ft. Area by O’Brien. Installed a stretch of geo grid and added 6 “ of type 5 rock. Trucks ran over it this morning and it was good to go , This proof roll was for chemical subgrade, will still need one for the rock.
Misc
Informational
10/18/2021
They had a tandem dump truck with a 21.3 ton load. Proof rolled just the curb line. Everything passed except for 2 storm boxes on O’Brien. They will make adjustments and reroll this area next week. RP 10-18-21
Misc
Informational
11/02/2021
They had a tandem dump truck with a 19.2 ton load. The base was solid, no deflection was noticed during the test. RP 11-2-21
Pavement-Surface Partial 11/3/2021 11/3/2021 11/03/2021
Misc
Informational
11/03/2021
Seal-O-Matic laid 1,459 tons of APWA Type 5 R for base on O’Brien, Patch and Killarney. KC Testing was on site doing compaction testing. RP 11-3-21
Pavement-Surface Partial 11/6/2021 11/6/2021 11/06/2021
Misc
Informational
11/03/2021
Seal-O-Matic laid 1,459 tons of APWA Type 5 R for base on O’Brien, Patch and Killarney. KC Testing was on site doing compaction testing. RP 11-3-21
Misc
Informational
11/06/2021
Seal-O-Matic laid down 825 tons of APWA Type 5 V asphalt for the roadway surface. KC Testing was on site doing compaction testing. We rejected 1 truck load based on the appearance of the material. RP 11-6-21
Erosion Control Inspection Partial 11/10/2021 11/10/2021 11/10/2021
Misc
Informational
11/10/2021
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Water Line - Construction Inspection Partial 11/17/2021 11/17/2021 11/17/2021
Misc
Informational
11/17/2021
Steve’s crew from ESS laid 225 feet of 6 inch C900 for water line 2. RP 11-17-21
Water Line - Construction Inspection Partial 12/2/2021 12/2/2021 12/02/2021
Misc
Informational
12/02/2021
Steve’s crew installed water pipe on O’Brien, Patch and Killarney. RP 12-2-21
Water Line - Hydrostatic Test Passed 12/2/2021 12/2/2021 12/02/2021
Misc
Informational
12/02/2021
The water lines on O’Brien, Patch and Killarney held 150 psi for over 2 hrs. RP 12-2-21
Water Line - Coliform Test 1 Partial 12/3/2021 12/3/2021 12/03/2021
Misc
Informational
12/03/2021
Chlorinated water lines for O’Brien, Patch and Killarney. Will let them set over the weekend. RP 12-3-21
Water Line - Coliform Test 1 Partial 12/6/2021 12/6/2021 12/07/2021
Misc
Informational
12/03/2021
Chlorinated water lines for O’Brien, Patch and Killarney. Will let them set over the weekend. RP 12-3-21
Misc
Informational
12/07/2021
Dechlorinated the water line. RP 12-6-21
Water Line - Coliform Test 1 Partial 12/7/2021 12/7/2021 12/07/2021
Misc
Informational
12/07/2021
Chlorinated water lines for O’Brien, Patch and Killarney. Will let them set over the weekend. RP 12-3-21
Misc
Informational
12/07/2021
Dechlorinated the water line. RP 12-6-21
Misc
Informational
12/07/2021
Pulled Bac T samples from Killarney, Patch Ct, O’Brien cul de sac and O’Brien Rd. Delivered samples to Keystone Laboratories for testing. RP 12-7-21
Water Line - Coliform Test 2 Partial 12/8/2021 12/8/2021 12/09/2021
Misc
Informational
12/09/2021
Collected second Bac T samples from O’Brien cul de sac, Patch Ct and O’Brien Rd. Chlorine was absent from the Killarney sample, so we took first sample also. Delivered samples to Keystone Laboratories for testing. RP 12-8-21
Water Line - Coliform Test 1 Partial 12/9/2021 12/9/2021 12/09/2021
Misc
Informational
12/07/2021
Chlorinated water lines for O’Brien, Patch and Killarney. Will let them set over the weekend. RP 12-3-21
Misc
Informational
12/07/2021
Dechlorinated the water line. RP 12-6-21
Misc
Informational
12/07/2021
Pulled Bac T samples from Killarney, Patch Ct, O’Brien cul de sac and O’Brien Rd. Delivered samples to Keystone Laboratories for testing. RP 12-7-21
Misc
Informational
12/09/2021
O’Brien cul de sac, Patch Ct, and O’Brien Rd passed their first Bac T test. RP 12-9-21
Water Line - Coliform Test 1 Passed 12/10/2021 12/10/2021 12/13/2021
Misc
Informational
12/09/2021
Chlorinated water lines for O’Brien, Patch and Killarney. Will let them set over the weekend. RP 12-3-21
Misc
Informational
12/09/2021
Dechlorinated the water line. RP 12-6-21
Misc
Informational
12/09/2021
Pulled Bac T samples from Killarney, Patch Ct, O’Brien cul de sac and O’Brien Rd. Delivered samples to Keystone Laboratories for testing. RP 12-7-21
Misc
Informational
12/09/2021
O’Brien cul de sac, Patch Ct, and O’Brien Rd passed their first Bac T test. RP 12-9-21
Misc
Informational
12/13/2021
Killarney passed it’s first Bac T test. RP 12-13-21
Water Line - Coliform Test 2 Partial 12/10/2021 12/10/2021 12/13/2021
Misc
Informational
12/09/2021
Collected second Bac T samples from O’Brien cul de sac, Patch Ct and O’Brien Rd. Chlorine was absent from the Killarney sample, so we took first sample also. Delivered samples to Keystone Laboratories for testing. RP 12-8-21
Misc
Informational
12/13/2021
O’Brien cul de sac, Patch Ct and O’Brien roadway passed their second Bac T testing. Pulling second sample for Killarney and delivered to Keystone Laboratories for testing. RP 12-13-21
Water Line - Coliform Test 2 Passed 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
Second sample for Killarney passed Bac T testing. RP 12-14-21
Pavement-Curb Construction Partial 12/14/2021 12/14/2021 12/15/2021
Misc
Informational
10/21/2021
ESS poured another 106 cubic yards of 4K KCMMB mix. RP 10-19-21
Misc
Informational
10/21/2021
They hand framed and poured 20 cubic yards of 4K KCMMB mix for storm inlets. RP 10-20-21
Misc
Informational
10/21/2021
Contractor finished pouring small sections of curb on O’Brien and working on finishing inlet box curbing and curb sections on Killarney. Noticed multiple manholes were in the process of being or needing to be raised. Need to verify they are wrapped after raising. 10/21 ES
Misc
Informational
12/15/2021
ESS replaced busted sections of curbing. The new sections were doweled into existing curbing. RP 12-15-21
Sidewalk Inspection Partial 12/14/2021 12/14/2021 12/15/2021
Misc
Informational
12/15/2021
Forms were placed and aggregate was present and compacted for the intersection and tracks alongside O’Brien and Killarney. RP 12-15-21
ADA Inspection Partial 12/14/2021 12/14/2021 12/15/2021
Misc
Informational
12/15/2021
Forms were placed and aggregate was present and compacted. Dowels were drilled into the curbs and the had the proper ADA warning panels. RP 12-15-21
Sanitary - Material Verification Passed 12/16/2021
Pavement-Aggregate Base Passed 12/16/2021
Pavement-Aggregate Base Passed 12/16/2021
Pavement-Stabilized Subgrade Passed 12/16/2021
Sanitary Sewer Construction Inspection Passed 12/16/2021
Misc
Informational
08/20/2021
Got the correct barrel section form American and set manhole 1-1. Also set and encased drop section. RP 7-7-21
Misc
Informational
08/20/2021
They laid 260 feet of sanitary pipe today. RP 7-8-21
Misc
Informational
08/20/2021
ESS brought a second crew out to work on the sanitary lines. Steve’s crew set manholes 1-2 and 1-3. They also laid 150 feet of sanitary pipe. John’s crew started on line 4. They exposed existing manhole 28-230 and were digging out the trench, when the breaker blew a hydraulic hose. RP 7-9-21
Misc
Informational
08/20/2021
John’s crew got the breaker repaired and cored into existing manhole 28-230. They also laid 30 feet of sanitary pipe. Steve’s crew set manhole 1-4 and laid 200 feet of sanitary pipe. RP 7-12-21
Misc
Informational
08/20/2021
John’s crew still have problems with their breaker. They laid 1 stick today. Steve’s crew set manhole 1-5. They also laid 50 feet of sanitary pipe and service lateral for lot 170. RP 7-13-21
Misc
Informational
08/20/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/20/2021
John’s crew set manhole 4-1 and laid 3 sanitary pipes. Steve’s crew laid service laterals for lots 166, 167, 168 and 169. KC Testing was on site doing compaction testing on sanitary line 1. RP 7-14-21
Misc
Informational
08/20/2021
John’s crew laid 125 feet of sanitary pipe. Steve’s crew also laid 125 feet of sanitary pipe. The also set manhole 1-6. RP 7-16-21
Misc
Informational
08/20/2021
The inverts have been poured on MH 1-5 and 1-6.l The back hoe broke down this afternoon. The other crew was working toward install MH 4-2, they were backfilling in the road with AB-3. This crew also hit rock so they were moving slow this afternoon.
Misc
Informational
08/20/2021
John’s crew set MH 4-2 and service lateral for lot 192. They pre-tested the main line underneath Killarney and found they have a leak. They are digging it back up to find the problem. Steve’s crew started working on line 2 out of MH 1-2. They laid 100 feet of sanitary pipe. KC Testing was on site doing compaction testing on line 1. RP 7-20-21
Misc
Informational
08/20/2021
John’s crew replaced the broken pipe with a new section connected with strong back fernco’s. They laid 150 feet of sanitary pipe and set MH 4-3. Steve’s crew laid 100 feet of sanitary pipe and set MH 2-1 They also set service laterals for lots 160 and 161. RP 7-21-21
Misc
Informational
08/20/2021
John’s crew set service laterals for lots 191, 193 and 194. They had KC Testing on site doing compaction testing. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-2 and service laterals for lots 159, 158 and 157. RP 7-22-21
Misc
Informational
08/20/2021
John’s crew filled the trench on Killarney with KCMMB 4K mixture. They had KC Testing on site doing compaction testing on Line 4. Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 156 and 162. Both crews worked on back filling the lines that were still open for the weekend. RP 7-23-21
Misc
Informational
08/20/2021
John’s crew laid 225 feet of sanitary pipe on line 4. Steve’s crew laid 100 feet of sanitary pipe. They also set MH 2-3 and service laterals for lots 155 and 163. KC Testing was on site for compaction testing with both crews. RP 7-26-21
Misc
Informational
08/20/2021
John’s crew poured trench checks and inverts on line 4. Steve’s crew back filled laterals and core cut existing MH 9-4. RP 7-27-21
Misc
Informational
08/20/2021
Both crews worked together on line 4 today. They laid 100 feet of sanitary pipe and service laterals for lots 198 and 187. They also had KC Testing on site doing compaction testing. RP 7-28-21
Misc
Informational
08/20/2021
Back down to just one crew. They laid 50 feet of sanitary pipe and set MH 4-4. KC Testing was on site doing compaction testing. RP 7-29-21
Misc
Informational
08/20/2021
Steve’s crew back filled and KC Testing was on site doing compaction testing. RP 7-30-21
Misc
Informational
08/20/2021
Steve’s crew laid 100 feet of sanitary pipe and service laterals for lots 186 and 185. RP 8-2-21
Misc
Informational
08/20/2021
Steve’s crew laid the last 50 feet of sanitary pipe and set MH 4-5 and service lateral for lot 184. KC Testing was on site doing compaction testing. RP 8-3-21
Misc
Informational
08/20/2021
Steve’s crew bored into existing MH 9-4 and installed the drop section. They also laid 100 feet of sanitary pipe and set MH 3-1. RP 8-4-21
Misc
Informational
08/20/2021
Steve’s crew laid 100 feet of sanitary pipe. RP 8-5-21
Misc
Informational
08/20/2021
Jone’s crew laid 100 feet of sanitary pipe and set service laterals for lots 150, 149, 180 and 179. KC Testing was on site doing compaction testing. RP 8-6-21
Misc
Informational
08/20/2021
Crew is installing pipe from MH 3-1 -3-2. They have installed wyes on lots 152 and 177. They will be setting MH 3-2 today.
Misc
Informational
08/20/2021
They laid 100 feet of sanitary pipe and service lateral for lot 153. KC Testing was on site doing compaction testing. RP 8-11-21
Misc
Informational
08/20/2021
They laid 100 feet of sanitary pipe and service lateral for lot 176. RP 8-12-21
Misc
Informational
08/20/2021
They laid 50 feet of sanitary pipe and set MH 3-3. They also laid service laterals for lots 154, 175, 174 and 173. RP 8-16-21
Misc
Informational
08/20/2021
Steve’s crew raised the 2 existing manholes and started pre-testing the sanitary lines. The 30 day clock starts today. RP 8-17-21
Misc
Informational
08/20/2021
They continued to pre test the sanitary lines (mandrel, air and vacuum). RP 8-18-21
Misc
Informational
08/20/2021
More pre-testing the sanitary lines. Looking for a leak in sanitary line 3. RP 8-19-21
Misc
Informational
08/20/2021
They found and repaired the leak on line 3. No other problems during the pre-testing. Now we are just waiting for the 30 days to expire for the actual testing. RP 8-20-21
Storm Sewer Construction Inspection Passed 12/16/2021
Misc
Informational
09/17/2021
They laid 160 feet of 15 inch HDPE storm pipe. They also set manhole 4-2 and curb inlet 4-3. RP 8-24-21
Misc
Informational
09/17/2021
They laid 250 feet of 18 inch HDPE storm pipe. They also set manhole 5-2 and poured collars and invert. RP 8-25-21
Misc
Informational
09/17/2021
They laid 100 feet of 18 inch HDPE storm pipe. They also set field inlets 9-2 and 10-2. They poured collars and inverts also. RP 8-26-21
Misc
Informational
09/17/2021
They ran into rock today, so they laid 50 feet of 18 inch HDPE storm pipe on line 9. They also poured trench checks on lines 9 and 10. RP 8-27-21
Misc
Informational
09/17/2021
Crew was rained out today. RP 8-31-21
Misc
Informational
09/17/2021
They laid 225 feet of 15 inch HDPE storm pipe. They also set curb inlets 5-3 and 5-4. RP 9-1-21
Misc
Informational
09/17/2021
They laid 60 feet of 24 inch HDPE storm pipe. They also poured collars and invert for storm manhole 7-2. RP 9-2-21
Misc
Informational
09/17/2021
Storms caused a rain out today. RP 9-3-21
Misc
Informational
09/17/2021
They laid 200 feet of 24 inch HDPE storm pipe. They also set storm manhole 7-3. RP 9-7-21
Misc
Informational
09/17/2021
They laid 35 feet of 15 inch HDPE storm pipe. They also set curb inlets 1-4, 1-3, 7-4 and poured collars and inverts. RP 9-8-21
Misc
Informational
09/17/2021
They laid 35 feet of 18 inch and 250 feet of 15 inch HDPE storm pipe. They also set storm manholes 2-2 and 2-3, along with curb inlet 2-4. RP 9-9-21
Misc
Informational
09/17/2021
They laid 300 feet of 15 inch HDPE storm pipe and set curb inlet 6-1. They also poured collars and inverts. RP 9-10-21
Misc
Informational
09/17/2021
They laid 70 feet of 15 inch and 35 feet of 18 inch HDPE storm pipe and set curb inlets 2-5, 6-2 and 7-5. They also poured collars and inverts, then back filled and cleaned up for the weekend. RP 9-11-21
Misc
Informational
09/17/2021
They’ve been breaking rock for line 3 for 2 days now. RP 9-15-21
Misc
Informational
09/17/2021
They laid 250 feet of 18 inch HDPE storm pipe and set curb inlet 3-3 and storm manhole 3-2. They also poured collars and inverts on all structures. RP 9-17-21
Sanitary Sewer - Air Test Passed 12/16/2021
Misc
Corrective Action Required
09/29/2021
9-27-21 8:00 AN Pressure test 4psi between 10min and 7:30min MH 9-4 to 3-1 passed. MH 2-2 to 2-1 passed MH 3-1 to 3-2 passed. MH 2-1 to 1-2 passed MH 3-2 to 3-3 passed. MH 2-3 to 2-2 passed MH 1-6 to 1-5 passed. MH 4-5 to 4-4 passed MH 1-5 to 1-4 passed. MH 4-4 to 4-3 FAILED start for 30days is 9-27-21 MH 1-4 to 1-3 passed. MH 4-3 to 4-2 passed MH 1-3 to 1-2 passed. MH 4-2 to 4-1 passed MH 1-2 to 1-1 passed. MH 4-1 to EX MH 2 passed MH 1-1 to 1-0 passed
Misc
Informational
12/16/2021
Passed all testing
Pavement-Surface Passed 12/16/2021
Misc
Informational
11/06/2021
Seal-O-Matic laid 1,459 tons of APWA Type 5 R for base on O’Brien, Patch and Killarney. KC Testing was on site doing compaction testing. RP 11-3-21
Misc
Informational
11/06/2021
Seal-O-Matic laid down 825 tons of APWA Type 5 V asphalt for the roadway surface. KC Testing was on site doing compaction testing. We rejected 1 truck load based on the appearance of the material. RP 11-6-21
Pavement-Curb Construction Passed 12/16/2021
Misc
Informational
12/15/2021
ESS poured another 106 cubic yards of 4K KCMMB mix. RP 10-19-21
Misc
Informational
12/15/2021
They hand framed and poured 20 cubic yards of 4K KCMMB mix for storm inlets. RP 10-20-21
Misc
Informational
12/15/2021
Contractor finished pouring small sections of curb on O’Brien and working on finishing inlet box curbing and curb sections on Killarney. Noticed multiple manholes were in the process of being or needing to be raised. Need to verify they are wrapped after raising. 10/21 ES
Misc
Informational
12/15/2021
ESS replaced busted sections of curbing. The new sections were doweled into existing curbing. RP 12-15-21
Sanitary Sewer - Air Test Passed 12/16/2021
Sanitary Sewer - Mandrel Passed 12/16/2021
Site Visit Partial 12/16/2021 12/16/2021 12/16/2021
Misc
Informational
11/02/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
11/02/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
11/02/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
11/02/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
11/02/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
11/02/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
11/02/2021
No work going on today due to the rain overnight.
Misc
Informational
11/02/2021
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
11/02/2021
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
12/16/2021
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Water Line - Construction Inspection Passed 12/17/2021 12/17/2021 12/18/2021
Misc
Informational
12/02/2021
Steve’s crew installed water pipe on O’Brien, Patch and Killarney. RP 12-2-21
Misc
Informational
12/18/2021
John’s crew completed water tie ins on Killarney and O’Brien. RP 12-17-21
ADA Inspection Passed 12/22/2021 12/22/2021 12/23/2021
Misc
Informational
12/15/2021
Forms were placed and aggregate was present and compacted. Dowels were drilled into the curbs and the had the proper ADA warning panels. RP 12-15-21
Misc
Informational
12/23/2021
ADA ramps were installed correctly. RP 12-22-21
Sidewalk Inspection Passed 12/22/2021 12/22/2021 12/23/2021
Misc
Informational
12/15/2021
Forms were placed and aggregate was present and compacted for the intersection and tracks alongside O’Brien and Killarney. RP 12-15-21
Misc
Informational
12/23/2021
Finished sidewalks meet LS and ADA specs. RP 12-22-21
Install Street and Stop Signs Passed 12/19/2021 12/19/2021 01/04/2022
Misc
Informational
01/04/2022
Street and stop signs have been installed. RP 1-4-22
Site Visit Partial 12/16/2021 12/16/2021 02/14/2022
Misc
Informational
12/16/2021
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
12/16/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
12/16/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
12/16/2021
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
12/16/2021
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
12/16/2021
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
12/16/2021
No work going on today due to the rain overnight.
Misc
Informational
12/16/2021
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
12/16/2021
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
12/16/2021
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
02/14/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Install Street and Stop Signs Passed 02/14/2022
Misc
Informational
02/14/2022
Street signage had been installed, but was missing spacers. Sign crew returned and corrected the errors. RP 2-14-22
Site Visit Partial 2/17/2022 2/17/2022 02/21/2022
Misc
Informational
02/14/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
02/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/14/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
02/14/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
02/14/2022
No work going on today due to the rain overnight.
Misc
Informational
02/14/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
02/14/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
02/14/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
02/14/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
02/21/2022
No work being done due to the snow storm. RP 2-17-22
Pavement-Curb Construction Partial 2/21/2022 2/21/2022 02/21/2022
Misc
Informational
02/21/2022
Richard’s crew from ESS is on site replacing chipped and busted curbing. RP 2-21-22
Site Visit Partial 2/22/2022 2/22/2022 02/24/2022
Misc
Informational
02/21/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
02/21/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/21/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/21/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/21/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
02/21/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
02/21/2022
No work going on today due to the rain overnight.
Misc
Informational
02/21/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
02/21/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
02/21/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
02/21/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
02/21/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/24/2022
No work being done today due to the snow. RP 2-24-22
Site Visit Partial 2/25/2022 2/25/2022 02/25/2022
Misc
Informational
02/24/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
02/24/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/24/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/24/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/24/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
02/24/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
02/24/2022
No work going on today due to the rain overnight.
Misc
Informational
02/24/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
02/24/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
02/24/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
02/24/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
02/24/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/24/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
02/25/2022
No work being done today that needs inspection. RP 2-25-22
Site Visit Partial 2/28/2022 2/28/2022 03/01/2022
Misc
Informational
02/25/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
02/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
02/25/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
02/25/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
02/25/2022
No work going on today due to the rain overnight.
Misc
Informational
02/25/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
02/25/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
02/25/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
02/25/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
02/25/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/25/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
02/25/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/01/2022
No work being done on site today. RP 3-1-22
Site Visit Partial 3/3/2022 3/3/2022 03/04/2022
Misc
Informational
03/01/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
03/01/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/01/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/01/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/01/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
03/01/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
03/01/2022
No work going on today due to the rain overnight.
Misc
Informational
03/01/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
03/01/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
03/01/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
03/01/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
03/01/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/01/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
03/01/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/01/2022
No work being done on site today. RP 3-1-22
Misc
Informational
03/04/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Pavement-Curb Construction Passed 3/2/2022 3/2/2022 03/04/2022
Misc
Informational
02/21/2022
Richard’s crew from ESS is on site replacing chipped and busted curbing. RP 2-21-22
Misc
Informational
03/04/2022
All curb repairs are done and look good. RP 3-4-22
Site Visit Partial 3/7/2022 3/7/2022 03/14/2022
Misc
Informational
03/04/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
03/04/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/04/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/04/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/04/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
03/04/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
03/04/2022
No work going on today due to the rain overnight.
Misc
Informational
03/04/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
03/04/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
03/04/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
03/04/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
03/04/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/04/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
03/04/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/04/2022
No work being done on site today. RP 3-1-22
Misc
Informational
03/04/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-10-22
Site Visit Partial 03/14/2022
Misc
Informational
03/14/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
03/14/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
03/14/2022
No work going on today due to the rain overnight.
Misc
Informational
03/14/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
03/14/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
03/14/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
03/14/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
03/14/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/14/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
03/14/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-1-22
Misc
Informational
03/14/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-10-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-14-22
Site Visit Partial 3/21/2022 3/21/2022 03/22/2022
Misc
Informational
03/14/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/14/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
03/14/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
03/14/2022
No work going on today due to the rain overnight.
Misc
Informational
03/14/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
03/14/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
03/14/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
03/14/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
03/14/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/14/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
03/14/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-1-22
Misc
Informational
03/14/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-10-22
Misc
Informational
03/14/2022
No work being done on site today. RP 3-14-22
Misc
Informational
03/22/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Erosion Control Inspection Failed 04/04/2022
Misc
Informational
11/10/2021
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Misc
Corrective Action Required
04/04/2022
Curb and field inlets are full of silt and there is excess silt in the roadways. RP 4-4-22
Record Drawing Review Partial 3/31/2022 04/05/2022
Misc
Corrective Action Required
04/05/2022
Water line is missing 1 valve riser lid at Patch and O’Brien. Extra fire hydrant on O’Brien, needs to removed from the plans (it was never installed). Existing sanitary manhole on line 1 is buried under silt. Storm end sections 1-1, 2-1, 3-1, 4-1, 5-1 and 7-1 need excess silt removed. End sections 3-1 and 4-1 need additional rip rap. End section 4-1 has standing water and will need to be regraded. Storm manhole 3-2 is buried under silt. Field inlets 9-2 and 10-2 need trash racks installed. Field inlet 10-2 also needs boarding and debris removed. RP 4-5-22
Erosion Control Inspection Partial 4/7/2022 4/7/2022 04/06/2022
Misc
Informational
04/04/2022
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Misc
Corrective Action Required
04/04/2022
Curb and field inlets are full of silt and there is excess silt in the roadways. RP 4-4-22
Misc
Informational
04/06/2022
ESS had someone come out and clean up the silt in the roadway and curb inlets. RP 4-6-22
Site Visit Partial 3/28/2022 3/28/2022 05/25/2022
Misc
Informational
03/22/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
03/22/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/22/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/22/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
03/22/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
03/22/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
03/22/2022
No work going on today due to the rain overnight.
Misc
Informational
03/22/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
03/22/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
03/22/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
03/22/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
03/22/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/22/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
03/22/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
03/22/2022
No work being done on site today. RP 3-1-22
Misc
Informational
03/22/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
03/22/2022
No work being done on site today. RP 3-10-22
Misc
Informational
03/22/2022
No work being done on site today. RP 3-14-22
Misc
Informational
03/22/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
05/25/2022
No work being done today with rain. 5/25/22 ES
Erosion Control Inspection Failed 06/06/2022
Misc
Informational
04/06/2022
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Misc
Corrective Action Required
04/06/2022
Curb and field inlets are full of silt and there is excess silt in the roadways. RP 4-4-22
Misc
Informational
04/06/2022
ESS had someone come out and clean up the silt in the roadway and curb inlets. RP 4-6-22
Misc
Corrective Action Required
06/06/2022
Silt and mud in roadway on O’Brien and cul de sacs of O’Brien and Patch. Need erosion control measures installed and roadways cleaned. 6/6/22 ES
ESC - (Vegetation/Ground Cover) Failed 06/06/2022
Misc
Corrective Action Required
06/06/2022
Large portion of plot remains not vegetated. Including entire hillside between Patch Ct and O’Brien going down towards creek. 6/6/22 ES
Erosion Control Inspection Partial 06/07/2022
Misc
Informational
06/06/2022
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Misc
Corrective Action Required
06/06/2022
Curb and field inlets are full of silt and there is excess silt in the roadways. RP 4-4-22
Misc
Informational
06/06/2022
ESS had someone come out and clean up the silt in the roadway and curb inlets. RP 4-6-22
Misc
Corrective Action Required
06/06/2022
Silt and mud in roadway on O’Brien and cul de sacs of O’Brien and Patch. Need erosion control measures installed and roadways cleaned. 6/6/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES
ESC - (Vegetation/Ground Cover) Partial 06/07/2022
Misc
Corrective Action Required
06/06/2022
Large portion of plot remains not vegetated. Including entire hillside between Patch Ct and O’Brien going down towards creek. 6/6/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES
Site Visit Partial 06/07/2022
Misc
Informational
05/25/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
05/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
05/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
05/25/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
05/25/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
05/25/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
05/25/2022
No work going on today due to the rain overnight.
Misc
Informational
05/25/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
05/25/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
05/25/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
05/25/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
05/25/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
05/25/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
05/25/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
05/25/2022
No work being done on site today. RP 3-1-22
Misc
Informational
05/25/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
05/25/2022
No work being done on site today. RP 3-10-22
Misc
Informational
05/25/2022
No work being done on site today. RP 3-14-22
Misc
Informational
05/25/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
05/25/2022
No work being done today with rain. 5/25/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES
Site Visit Partial 06/15/2022
Misc
Informational
06/07/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
06/07/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/07/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/07/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/07/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
06/07/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
06/07/2022
No work going on today due to the rain overnight.
Misc
Informational
06/07/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
06/07/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
06/07/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
06/07/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
06/07/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/07/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
06/07/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
06/07/2022
No work being done on site today. RP 3-1-22
Misc
Informational
06/07/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
06/07/2022
No work being done on site today. RP 3-10-22
Misc
Informational
06/07/2022
No work being done on site today. RP 3-14-22
Misc
Informational
06/07/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/07/2022
No work being done today with rain. 5/25/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES ESS was on site doing some surveying for some fill work to be done. 6/14/22 ES
Grading/Excavation/Fill Inspection Partial 06/15/2022
Misc
Informational
06/15/2022
Front end loader on site grading sites. 6/15/22 ES
Site Visit Partial 06/15/2022
Misc
Informational
06/15/2022
ESS was on site today to start mass stripping the area. RP 5-25-21
Misc
Informational
06/15/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/15/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/15/2022
ESS still prepping the job site. Blasters have started drilling to blast out the rock shelf’s. RP 6-4-21
Misc
Informational
06/15/2022
EDS blasted the the area around Killarney. They have also started drilling the O’Brien / Patch area. RP 6-8-21
Misc
Informational
06/15/2022
EDS finished blasting along Patch and O’Brien. ESS has 2 crews laying sanitary pipe and 1 crew breaking up the large rocks. RP 7-12-21
Misc
Informational
06/15/2022
No work going on today due to the rain overnight.
Misc
Informational
06/15/2022
ESS is cutting roadways down to grade. RP 10-1-21
Misc
Informational
06/15/2022
Water had an issue with MH 28450 having too many risers. Found out the barrel section was a flat top versus a cone. Water came back out and approved the risers and manhole. RP 11-2-21
Misc
Informational
06/15/2022
Went with Kent Monter to look at the drainage plan for Killarney between the old subdivision and the new one. Kent believes that there will be no drainage issues. RP 12-16-21
Misc
Informational
06/15/2022
Welch was on site hydro seeding and laying straw. Construction debris still needs to be removed. No one else was on site today. RP 2-14-22
Misc
Informational
06/15/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/15/2022
No work being done today due to the snow. RP 2-24-22
Misc
Informational
06/15/2022
No work being done today that needs inspection. RP 2-25-22
Misc
Informational
06/15/2022
No work being done on site today. RP 3-1-22
Misc
Informational
06/15/2022
Rudy from ESS came out for tracer wire testing. Water and sanitary both passed testing. RP 3-4-22
Misc
Informational
06/15/2022
No work being done on site today. RP 3-10-22
Misc
Informational
06/15/2022
No work being done on site today. RP 3-14-22
Misc
Informational
06/15/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/15/2022
No work being done today with rain. 5/25/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES ESS was on site doing some surveying for some fill work to be done. 6/14/22 ES First home site basement is being excavated. Another loader working on lots on north side of O’Brien. 6/15/22 ES
Erosion Control Inspection Partial 06/15/2022
Misc
Informational
06/07/2022
Welch Erosion installed gutter buddies properly on O’Brien, Patch and Killarney. RP 11-10-21
Misc
Corrective Action Required
06/07/2022
Curb and field inlets are full of silt and there is excess silt in the roadways. RP 4-4-22
Misc
Informational
06/07/2022
ESS had someone come out and clean up the silt in the roadway and curb inlets. RP 4-6-22
Misc
Corrective Action Required
06/07/2022
Silt and mud in roadway on O’Brien and cul de sacs of O’Brien and Patch. Need erosion control measures installed and roadways cleaned. 6/6/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES Silt fence is still intact and vegetation is now growing down offsite sewer line. 6/15/22 ES
ESC - (Vegetation/Ground Cover) Partial 06/15/2022
Misc
Corrective Action Required
06/07/2022
Large portion of plot remains not vegetated. Including entire hillside between Patch Ct and O’Brien going down towards creek. 6/6/22 ES Welch silt fence was onsite putting seed, straw, and silt fence down. 6/7/22 ES Vegetation has began to establish in areas where Welch treated last week and has started to grow down the hillside for the sewer running down creek to tie in point. 6/15/22 ES
Record Drawing Review Partial 11/02/2022
Misc
Corrective Action Required
04/05/2022
Water line is missing 1 valve riser lid at Patch and O’Brien. Extra fire hydrant on O’Brien, needs to removed from the plans (it was never installed). Existing sanitary manhole on line 1 is buried under silt. Storm end sections 1-1, 2-1, 3-1, 4-1, 5-1 and 7-1 need excess silt removed. End sections 3-1 and 4-1 need additional rip rap. End section 4-1 has standing water and will need to be regraded. Storm manhole 3-2 is buried under silt. Field inlets 9-2 and 10-2 need trash racks installed. Field inlet 10-2 also needs boarding and debris removed. RP 4-5-22 Water line 1 is still missing valve riser lid at Patch and O'Brien. Storm end sections had been cleaned up and additional rip rap added where necessary. 9-2 and 10-2 inlets also had trash racks installed and debris removed. 11/2/22 ES
Documents & Images
Date Uploaded File Type Document Name
02/18/2021 Receipt Receipt for transaction: 2021-000771
02/22/2021 Approved Plans Woodside Ridge 2nd Water Approved 2.22.21
02/22/2021 Approved Plans Woodside Ridge 2nd Sanitary Sewer Plans Approved 2.22.21
02/25/2021 Approved Plans Woodside Ridge 2nd Site Disturbance Approved 2.22.21
04/07/2021 Approved Plans Woodside Ridge 2nd Street & Storm Revised 3.23.21 Re-approved 4.7.21
05/25/2021 Letter INSPECTION SUMMARY
06/04/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
07/05/2021 Letter INSPECTION SUMMARY
07/08/2021 Letter INSPECTION SUMMARY
07/08/2021 Letter INSPECTION SUMMARY
07/09/2021 Letter INSPECTION SUMMARY
07/12/2021 Letter INSPECTION SUMMARY
07/12/2021 Letter INSPECTION SUMMARY
07/13/2021 Letter INSPECTION SUMMARY
07/16/2021 Letter INSPECTION SUMMARY
07/19/2021 Letter INSPECTION SUMMARY
07/20/2021 Letter INSPECTION SUMMARY
07/20/2021 Letter INSPECTION SUMMARY
07/21/2021 Letter INSPECTION SUMMARY
07/22/2021 Letter INSPECTION SUMMARY
07/23/2021 Letter INSPECTION SUMMARY
07/26/2021 Letter INSPECTION SUMMARY
07/27/2021 Letter INSPECTION SUMMARY
07/28/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/04/2021 Letter INSPECTION SUMMARY
08/05/2021 Letter INSPECTION SUMMARY
08/06/2021 Letter INSPECTION SUMMARY
08/09/2021 Letter INSPECTION SUMMARY
08/11/2021 Letter INSPECTION SUMMARY
08/11/2021 Letter INSPECTION SUMMARY
08/12/2021 Letter INSPECTION SUMMARY
08/16/2021 Letter INSPECTION SUMMARY
08/17/2021 Letter INSPECTION SUMMARY
08/18/2021 Letter INSPECTION SUMMARY
08/19/2021 Letter INSPECTION SUMMARY
08/20/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/24/2021 Letter INSPECTION SUMMARY
08/25/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/27/2021 Letter INSPECTION SUMMARY
08/31/2021 Letter INSPECTION SUMMARY
09/01/2021 Letter INSPECTION SUMMARY
09/02/2021 Letter INSPECTION SUMMARY
09/03/2021 Letter INSPECTION SUMMARY
09/07/2021 Letter INSPECTION SUMMARY
09/08/2021 Letter INSPECTION SUMMARY
09/09/2021 Letter INSPECTION SUMMARY
09/10/2021 Letter INSPECTION SUMMARY
09/11/2021 Letter INSPECTION SUMMARY
09/15/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/21/2021 Letter INSPECTION SUMMARY
09/24/2021 Letter INSPECTION SUMMARY
09/27/2021 Letter INSPECTION SUMMARY
09/29/2021 Letter INSPECTION SUMMARY
09/29/2021 Letter INSPECTION SUMMARY
09/29/2021 Letter INSPECTION SUMMARY
10/01/2021 Letter INSPECTION SUMMARY
10/01/2021 Letter INSPECTION SUMMARY
10/01/2021 Letter INSPECTION SUMMARY
10/04/2021 Letter INSPECTION SUMMARY
10/04/2021 Approved Plans Woodside Ridge 2nd Plat Revised Curb Ramps - Approved 10.4.21
10/05/2021 Letter INSPECTION SUMMARY
10/06/2021 Letter INSPECTION SUMMARY
10/06/2021 Letter INSPECTION SUMMARY
10/13/2021 Approved Plans Woodside Ridge 2nd Plat Curb Ramps1 - Approved 10.13.21
10/18/2021 Letter INSPECTION SUMMARY
10/19/2021 Letter INSPECTION SUMMARY
10/19/2021 Letter INSPECTION SUMMARY
10/20/2021 Letter INSPECTION SUMMARY
10/21/2021 Letter INSPECTION SUMMARY
10/27/2021 Letter INSPECTION SUMMARY
10/27/2021 Letter INSPECTION SUMMARY
11/02/2021 Letter INSPECTION SUMMARY
11/02/2021 Letter INSPECTION SUMMARY
11/06/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/17/2021 Letter INSPECTION SUMMARY
12/02/2021 Letter INSPECTION SUMMARY
12/02/2021 Letter INSPECTION SUMMARY
12/03/2021 Letter INSPECTION SUMMARY
12/07/2021 Letter INSPECTION SUMMARY
12/07/2021 Letter INSPECTION SUMMARY
12/09/2021 Letter INSPECTION SUMMARY
12/09/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/18/2021 Letter INSPECTION SUMMARY
12/23/2021 Letter INSPECTION SUMMARY
12/23/2021 Letter INSPECTION SUMMARY
01/04/2022 Letter INSPECTION SUMMARY
01/21/2022 Receipt Receipt for transaction:2022-000367
02/14/2022 Letter INSPECTION SUMMARY
02/14/2022 Letter INSPECTION SUMMARY
02/21/2022 Letter INSPECTION SUMMARY
02/21/2022 Letter INSPECTION SUMMARY
02/24/2022 Letter INSPECTION SUMMARY
02/25/2022 Letter INSPECTION SUMMARY
03/01/2022 Letter INSPECTION SUMMARY
03/04/2022 Letter INSPECTION SUMMARY
03/04/2022 Letter INSPECTION SUMMARY
03/14/2022 Letter INSPECTION SUMMARY
03/14/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/27/2022 Plans Woodside Ridge 2nd_Water_As-builts_22-03-24
03/27/2022 Plans Woodside Ridge 2nd_Sanitary_As-builts_22-03-24
03/27/2022 Plans Woodside Ridge 2nd_Street & Storm_As-builts_22-03-24
03/27/2022 Plans WoodsideRidge2nd_MasterDrinagePlan_2022_03_24
04/04/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/06/2022 Letter INSPECTION SUMMARY
04/06/2022 Letter INSPECTION SUMMARY
05/25/2022 Letter INSPECTION SUMMARY
06/01/2022 Letter DE-Certificate of Substantial Completion Single Lot
06/06/2022 Letter INSPECTION SUMMARY
06/06/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/15/2022 Letter INSPECTION SUMMARY
06/15/2022 Letter INSPECTION SUMMARY
06/15/2022 Letter INSPECTION SUMMARY
06/15/2022 Letter INSPECTION SUMMARY
06/15/2022 Letter INSPECTION SUMMARY
09/20/2022 Letter DE-Certificate of Substantial Completion Single Lot
09/20/2022 Activity Document Woodside Ridge 2nd Plat Substantial Completion
10/11/2022 Letter DE-Punch List
10/11/2022 Activity Document Woodside Ridge 2nd Plat Punch List
10/11/2022 Activity Document Woodside Ridge 2nd Plat Substantial Completion
10/27/2022 Plans 22-10-27_Woodside Ridge 2nd_Street & Storm_Asbuilts
10/27/2022 Letter 22-10-27_Woodside Ridge 2nd Plat_Comment Response Letter
11/02/2022 Letter INSPECTION SUMMARY
11/02/2022 Letter INSPECTION SUMMARY
02/09/2023 Security Document Woodside Ridge 2nd Plat Final Affidavit and Agreement
02/09/2023 Security Document Woodside Ridge 2nd Plat Maintenance Bond
04/17/2023 Letter 23-04-17_Woodside Ridge 2nd Plat_Comment Response Letter
04/17/2023 Plans 23-04-17_Woodside Ridge 2nd Plat_Master Drainage Plan_As-builts
04/17/2023 Plans 23-04-17_Woodside Ridge 2nd Plat_Street & Storm Plans_As-builts
08/07/2023 Letter DE-Certificate of Final Acceptance (Commercial)

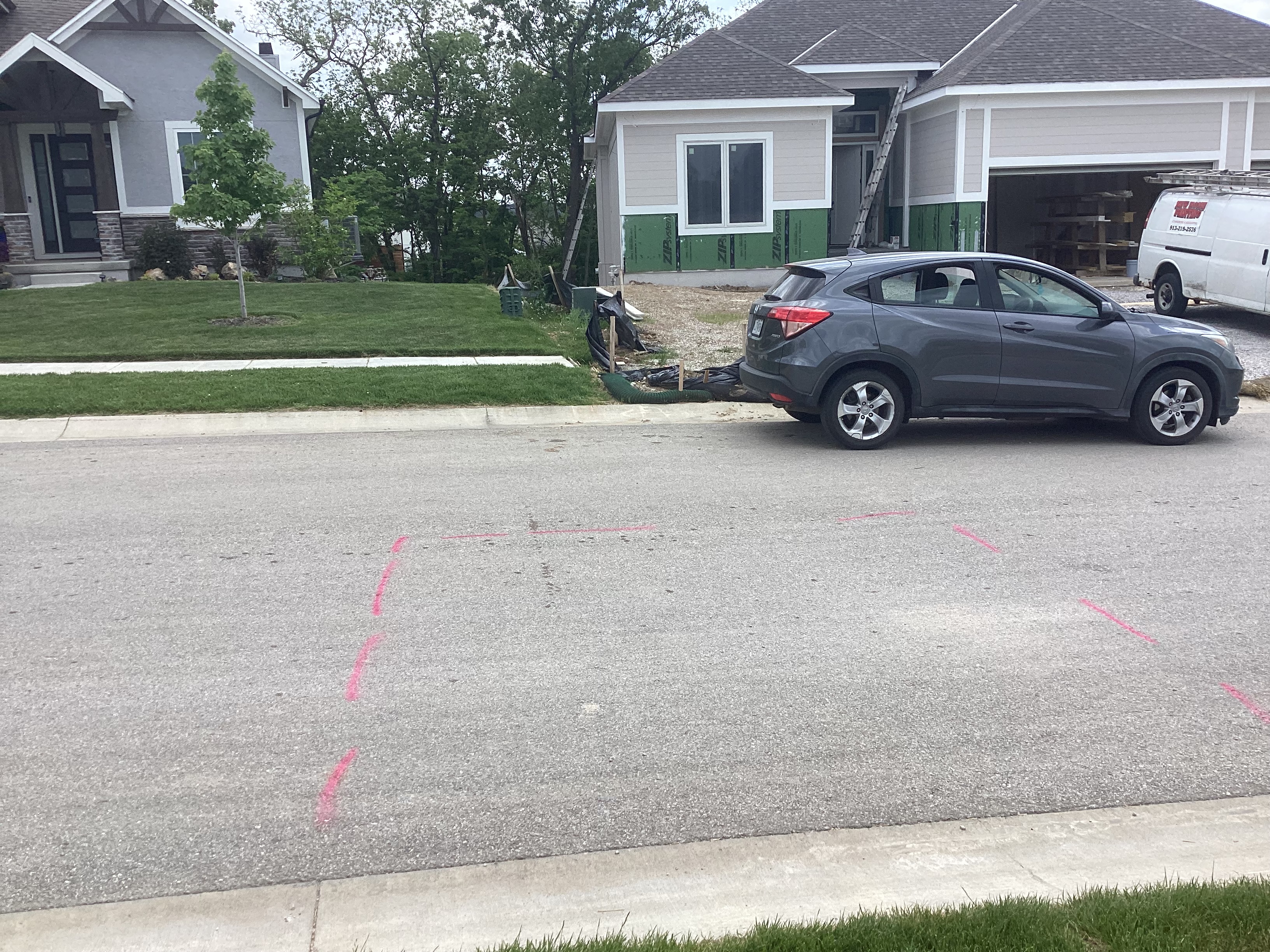

05/14/2025 Curb 2075 NW Obrien

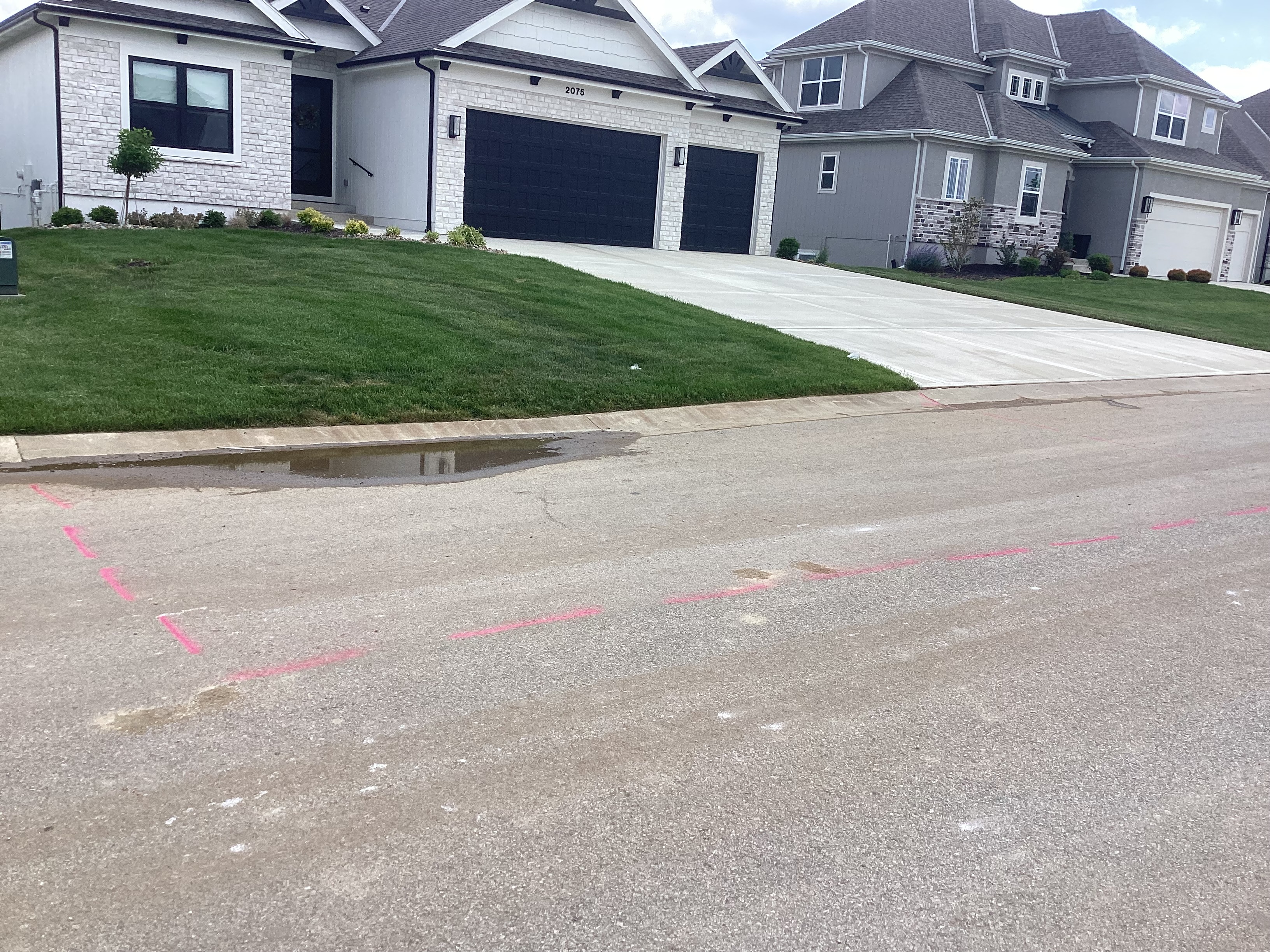

05/14/2025 2115 NW Obrien
05/14/2025 Letter PW ROW Inspections Report
06/26/2025 Letter PW ROW Inspections Report
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
