Permit Application Status

PRSITE20214153

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSITE20214153
Development - Site
Final Acceptance
DEVELOPMENT COMPLETE
LOT 7A - STREETS OF WEST PRYOR - SIGNATURE AT WEST PRYOR - SITE DEVELOPMENT GRADING ONLY ISSUED 9.2.21 FULL SITE PERMIT ISSUED 9.30.21
08/10/2021
09/30/2021
01/24/2024
Locations
Contacts
DRAKE DEVELOPMENT, LLC, Address:7200 West 132nd Street; Suite 150
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 08/10/2021 09/02/2021
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $603.00 $603.00 Paid 09/27/2021
91100C9-Water Insp Fee $9,734.10 $9,734.10 Paid 09/27/2021
9110072-Water Test Fee $1,000.00 $1,000.00 Paid 09/27/2021
9110068-Storm Fee $7,495.35 $7,495.35 Paid 09/27/2021
9110081-Paved Surface Inspection Fee $28,356.12 $28,356.12 Paid 09/27/2021
9110071-Site Grading Fee $3,447.38 $3,447.38 Paid 08/31/2021
8331401-Water Tap Fee $58,490.00 $58,490.00 Paid 09/27/2021
8350015-Water Meter Fee $6,439.13 $6,439.13 Paid 09/27/2021
9110069-After Hours Inspections (Public Works)(Per Hour) $400.00 $400.00 Paid 05/02/2022
8350015-Water Meter Fee $6,439.13 $6,439.13 Paid 05/02/2022
$12,878.26
8331401-Water Tap Fee $58,490.00 $58,490.00 Paid 05/02/2022
$116,980.00
8350015-Water Meter Fee $2,325.11 $2,325.11 Paid 05/12/2022
$16,023.66
8331401-Water Tap Fee $2,435.00 $2,435.00 Paid 05/12/2022
$129,165.00
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary - Material Verification Partial 11/9/2021 11/9/2021 11/09/2021
Misc
Informational
11/09/2021
Sanitary materials onsite include: 6”, 8”, 10” SDR26 pipe, wye fittings, bends and max adapters for the wye connections. Still waiting on all manhole components(barrels, cones, adjustment risers, rings and lids). 11/9 ES.
Water - Material Verification Partial 11/9/2021 11/9/2021 11/09/2021
Misc
Informational
11/09/2021
Water materials onsite: 6”, 8” and 12” C900 pipe, 6” and 8” gate valves, multiple fittings and bend connections and gaskets. Did notice some adapters were wrong, not epoxy coated, they are going to get these replaced through manufacturer. Still waiting to verify 12” butterfly valves, or fire hydrants.
Water - Material Verification Partial 11/15/2021 11/15/2021 11/15/2021
Misc
Informational
11/09/2021
Water materials onsite: 6”, 8” and 12” C900 pipe, 6” and 8” gate valves, multiple fittings and bend connections and gaskets. Did notice some adapters were wrong, not epoxy coated, they are going to get these replaced through manufacturer. Still waiting to verify 12” butterfly valves, or fire hydrants.
Misc
Informational
11/15/2021
They received fire hydrants today. They are Kennedy Guardian K-81D with epoxy base. Still waiting on some tees and 12” gate valve. Informed Matt and Earl that they will need ferrous metal valve risers because all risers look to be in the parking lot. RP 11-15-21
Water Line - Construction Inspection Partial 11/15/2021 11/15/2021 11/15/2021
Misc
Informational
11/15/2021
Matt’s crew laid 200 feet of 12 inch C900 water pipe and set FH at station 5+26 on water line B. RP 11-15-21
Water Line - Construction Inspection Partial 11/16/2021 11/16/2021 11/16/2021
Misc
Informational
11/15/2021
Matt’s crew laid 200 feet of 12 inch C900 water pipe and set FH at station 5+26 on water line B. RP 11-15-21
Misc
Informational
11/16/2021
Earl’s crew laid 100 feet of 12 inch C900 for water line B. They had to stop and wait for fittings, which didn’t show up until the end of the day. RP 11-16-21
Sanitary - Material Verification Partial 11/10/2021 11/10/2021 11/17/2021
Misc
Informational
11/09/2021
Sanitary materials onsite include: 6”, 8”, 10” SDR26 pipe, wye fittings, bends and max adapters for the wye connections. Still waiting on all manhole components(barrels, cones, adjustment risers, rings and lids). 11/9 ES.
Misc
Informational
11/17/2021
Sanitary Manhole base, barrel, and cone sections were delivered, manufactured by Barbour with correct steps and A-Locks. Still waiting for castings and lids. 11/17 ES
Water Line - Construction Inspection Partial 11/17/2021 11/17/2021 11/17/2021
Misc
Informational
11/16/2021
Matt’s crew laid 200 feet of 12 inch C900 water pipe and set FH at station 5+26 on water line B. RP 11-15-21
Misc
Informational
11/16/2021
Earl’s crew laid 100 feet of 12 inch C900 for water line B. They had to stop and wait for fittings, which didn’t show up until the end of the day. RP 11-16-21
Misc
Informational
11/17/2021
Matt and Earl’s crews laid the last 300 feet of 12 inch C900 for water line B. RP 11-17-21
Water Line - Thrust Restraint Passed 12/6/2021 12/6/2021 12/07/2021
Misc
Informational
12/07/2021
ESS poured thrust blocks for the fire risers for both buildings. RP 12-6-21
Pavement-Stabilized Subgrade Partial 12/13/2021 12/13/2021 12/13/2021
Misc
Informational
12/13/2021
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21
Pavement-Proof Roll Partial 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Pavement-Stabilized Subgrade Passed 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
They tilled in 12 inches of Portland Cement at 6% moisture for the parking lot. RP 12-14-21
Pavement-Proof Roll Partial 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
12/14/2021
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Sewer Service Inspection Passed 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
The western apartment pad connected it’s service line to the sanitary lateral using a hard back Fernco connector. RP 12-14-21
Pavement-Aggregate Base Partial 12/14/2021 12/14/2021 12/14/2021
Misc
Informational
12/14/2021
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Pavement-Proof Roll Partial 12/15/2021 12/15/2021 12/15/2021
Misc
Informational
12/14/2021
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
12/14/2021
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
12/15/2021
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Pavement-Aggregate Base Partial 12/15/2021 12/15/2021 12/15/2021
Misc
Informational
12/14/2021
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
12/15/2021
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Pavement-Curb Construction Partial 12/16/2021 12/16/2021 12/16/2021
Misc
Informational
12/16/2021
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Pavement-Curb Construction Partial 12/17/2021 12/17/2021 12/18/2021
Misc
Informational
12/16/2021
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
12/18/2021
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Pavement-Curb Construction Partial 12/20/2021 12/20/2021 12/21/2021
Misc
Informational
12/18/2021
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
12/18/2021
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
12/21/2021
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Pavement-Proof Roll Partial 12/21/2021 12/21/2021 12/21/2021
Misc
Informational
12/15/2021
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
12/15/2021
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
12/15/2021
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
12/21/2021
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Pavement-Surface Partial 12/22/2021 12/22/2021 12/22/2021
Misc
Informational
12/22/2021
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Pavement-Curb Construction Partial 12/21/2021 12/21/2021 12/22/2021
Misc
Informational
12/21/2021
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
12/21/2021
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
12/21/2021
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
12/22/2021
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Water - Material Verification Passed 11/16/2021 11/16/2021 12/22/2021
Misc
Informational
11/15/2021
Water materials onsite: 6”, 8” and 12” C900 pipe, 6” and 8” gate valves, multiple fittings and bend connections and gaskets. Did notice some adapters were wrong, not epoxy coated, they are going to get these replaced through manufacturer. Still waiting to verify 12” butterfly valves, or fire hydrants.
Misc
Informational
11/15/2021
They received fire hydrants today. They are Kennedy Guardian K-81D with epoxy base. Still waiting on some tees and 12” gate valve. Informed Matt and Earl that they will need ferrous metal valve risers because all risers look to be in the parking lot. RP 11-15-21
Misc
Informational
12/22/2021
All materials meets water specifications. RP 11-22-21
Pavement-Surface Partial 12/23/2021 12/23/2021 12/23/2021
Misc
Informational
12/22/2021
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
12/23/2021
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Water Line - Hydrostatic Test Passed 12/22/2021 12/22/2021 01/07/2022
Misc
Informational
01/07/2022
The water main and fire risers held over 200 psi for 2 hours. RP 1-7-22
Water Line - Coliform Test 1 Partial 1/10/2022 1/10/2022 01/12/2022
Misc
Informational
01/12/2022
All water lines were chlorinated. RP 1-11-22
Water Line - Coliform Test 1 Partial 01/12/2022
Misc
Informational
01/12/2022
All water lines were chlorinated. RP 1-11-22
Misc
Informational
01/12/2022
All water lines were dechlorinated. RP 1-12-22
Water Line - Coliform Test 1 Partial 1/13/2022 1/13/2022 01/13/2022
Misc
Informational
01/12/2022
All water lines were chlorinated. RP 1-11-22
Misc
Informational
01/12/2022
All water lines were dechlorinated. RP 1-12-22
Misc
Informational
01/13/2022
Collected samples for first Bac T testing. Delivered samples to Keystone Laboratories for testing. RP 1-13-22
Water Line - Coliform Test 2 Partial 1/14/2022 1/14/2022 01/14/2022
Misc
Informational
01/14/2022
1-14-21 AN second set of water samples have taken at 8am and delivered for testing Line a,b,c
Water Line - Coliform Test 1 Passed 1/18/2022 1/18/2022 01/18/2022
Misc
Informational
01/13/2022
All water lines were chlorinated. RP 1-11-22
Misc
Informational
01/13/2022
All water lines were dechlorinated. RP 1-12-22
Misc
Informational
01/13/2022
Collected samples for first Bac T testing. Delivered samples to Keystone Laboratories for testing. RP 1-13-22
Misc
Informational
01/18/2022
First Bac T samples passed testing. RP 1-18-22
Water Line - Coliform Test 2 Passed 1/18/2022 1/18/2022 01/18/2022
Misc
Informational
01/14/2022
1-14-21 AN second set of water samples have taken at 8am and delivered for testing Line a,b,c
Misc
Informational
01/18/2022
Second Bac T samples passed testing. RP 1-18-22
Water Line - Construction Inspection Passed 12/7/2021 12/7/2021 01/18/2022
Misc
Informational
11/17/2021
Matt’s crew laid 200 feet of 12 inch C900 water pipe and set FH at station 5+26 on water line B. RP 11-15-21
Misc
Informational
11/17/2021
Earl’s crew laid 100 feet of 12 inch C900 for water line B. They had to stop and wait for fittings, which didn’t show up until the end of the day. RP 11-16-21
Misc
Informational
11/17/2021
Matt and Earl’s crews laid the last 300 feet of 12 inch C900 for water line B. RP 11-17-21
Site Visit Partial 2/4/2022 2/4/2022 02/04/2022
Misc
Informational
02/04/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Site Visit Partial 2/7/2022 2/7/2022 02/08/2022
Misc
Corrective Action Required
02/08/2022
Received a citizen complaint concerning a lane closure on Lowenstein. Had Nick Scott from PW ROW go out to talk with Capital Electric about the traffic permit. They just needed to add a flagged ahead signage and station an flagged to assist traffic. They were very cordial and agreed to make to required changes. RP 2-8-22
Sanitary - Material Verification Passed 11/18/2021 11/18/2021 02/09/2022
Misc
Informational
11/17/2021
Sanitary materials onsite include: 6”, 8”, 10” SDR26 pipe, wye fittings, bends and max adapters for the wye connections. Still waiting on all manhole components(barrels, cones, adjustment risers, rings and lids). 11/9 ES.
Misc
Informational
11/17/2021
Sanitary Manhole base, barrel, and cone sections were delivered, manufactured by Barbour with correct steps and A-Locks. Still waiting for castings and lids. 11/17 ES
Misc
Informational
02/09/2022
Correct castings and lid were delivered. RP 11-19-21
Sanitary Sewer Construction Inspection Partial 11/9/2021 11/9/2021 02/10/2022
Misc
Informational
02/10/2022
All sanitary lines have been installed. Just need to test and camera the lines. RP 2-10-22
Site Visit Partial 2/11/2022 2/11/2022 02/21/2022
Misc
Informational
02/08/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
02/21/2022
No work being done due to the snow storm. RP 2-17-22
Site Visit Partial 2/22/2022 2/22/2022 02/22/2022
Misc
Informational
02/21/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
02/21/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/22/2022
No utility or exterior work being done today. RP 2-22-22
Site Visit Partial 2/24/2022 2/24/2022 02/24/2022
Misc
Informational
02/22/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
02/22/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/22/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
02/24/2022
No exterior work being done today due to snow. RP 2-24-22

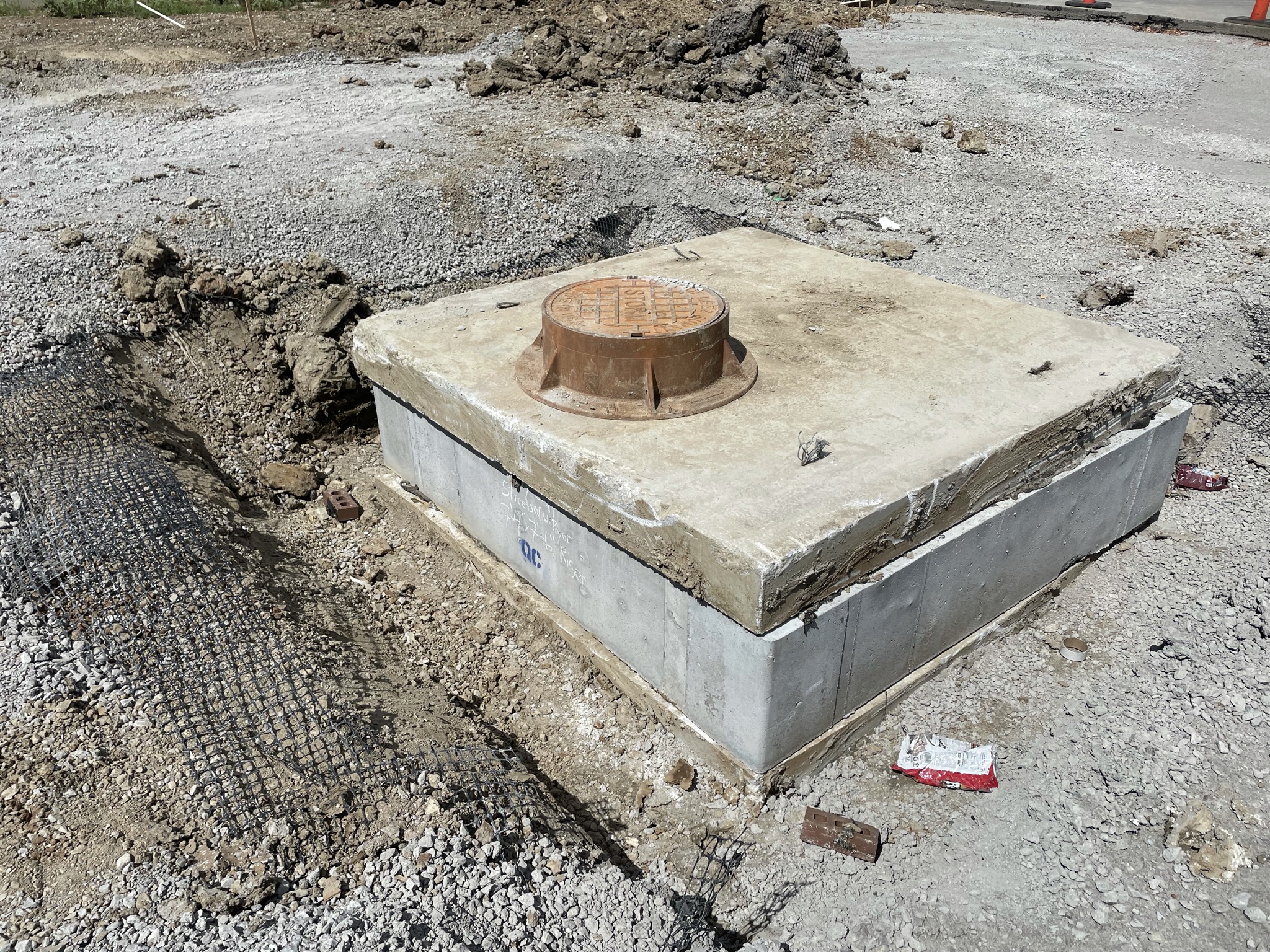

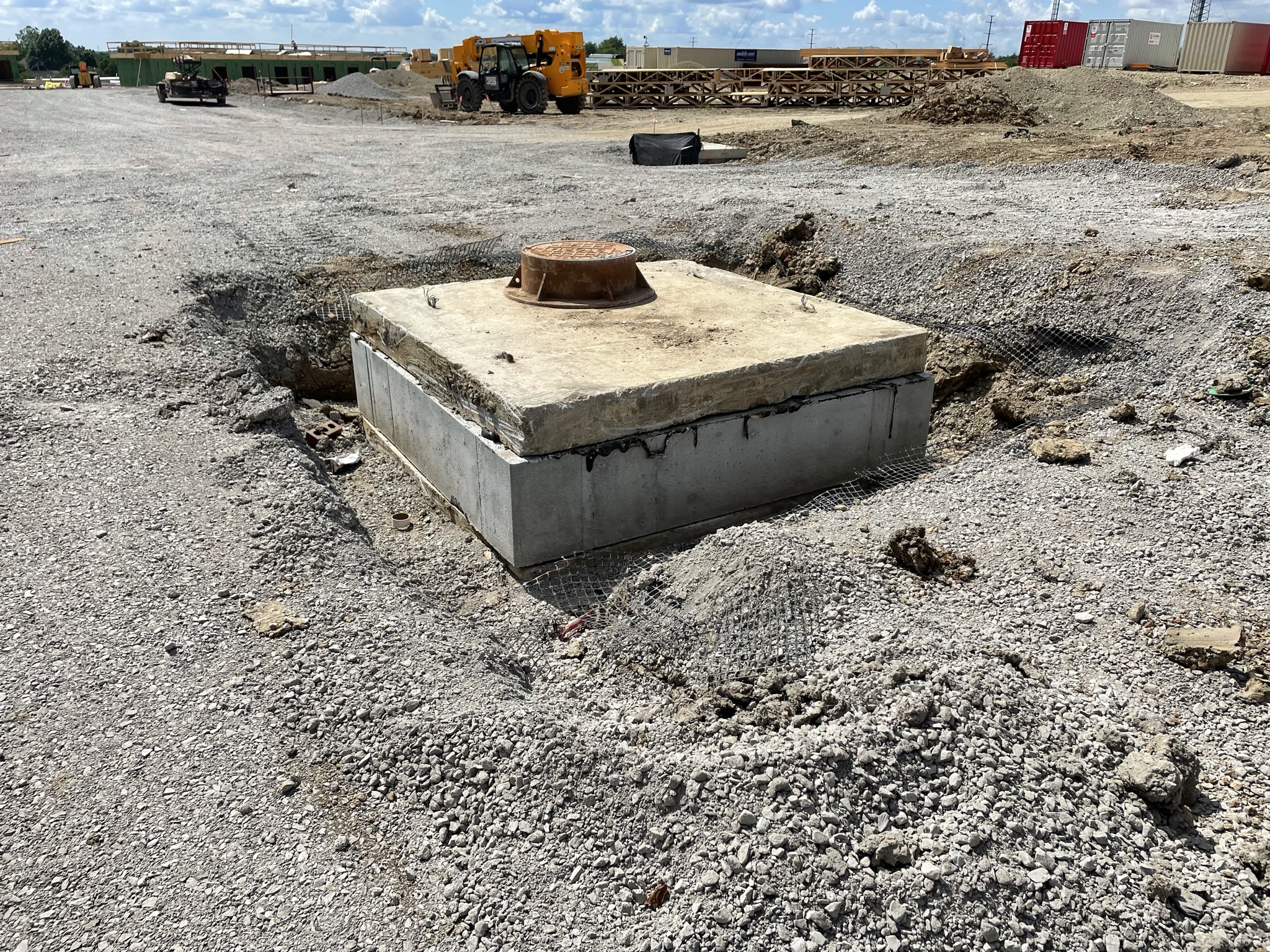

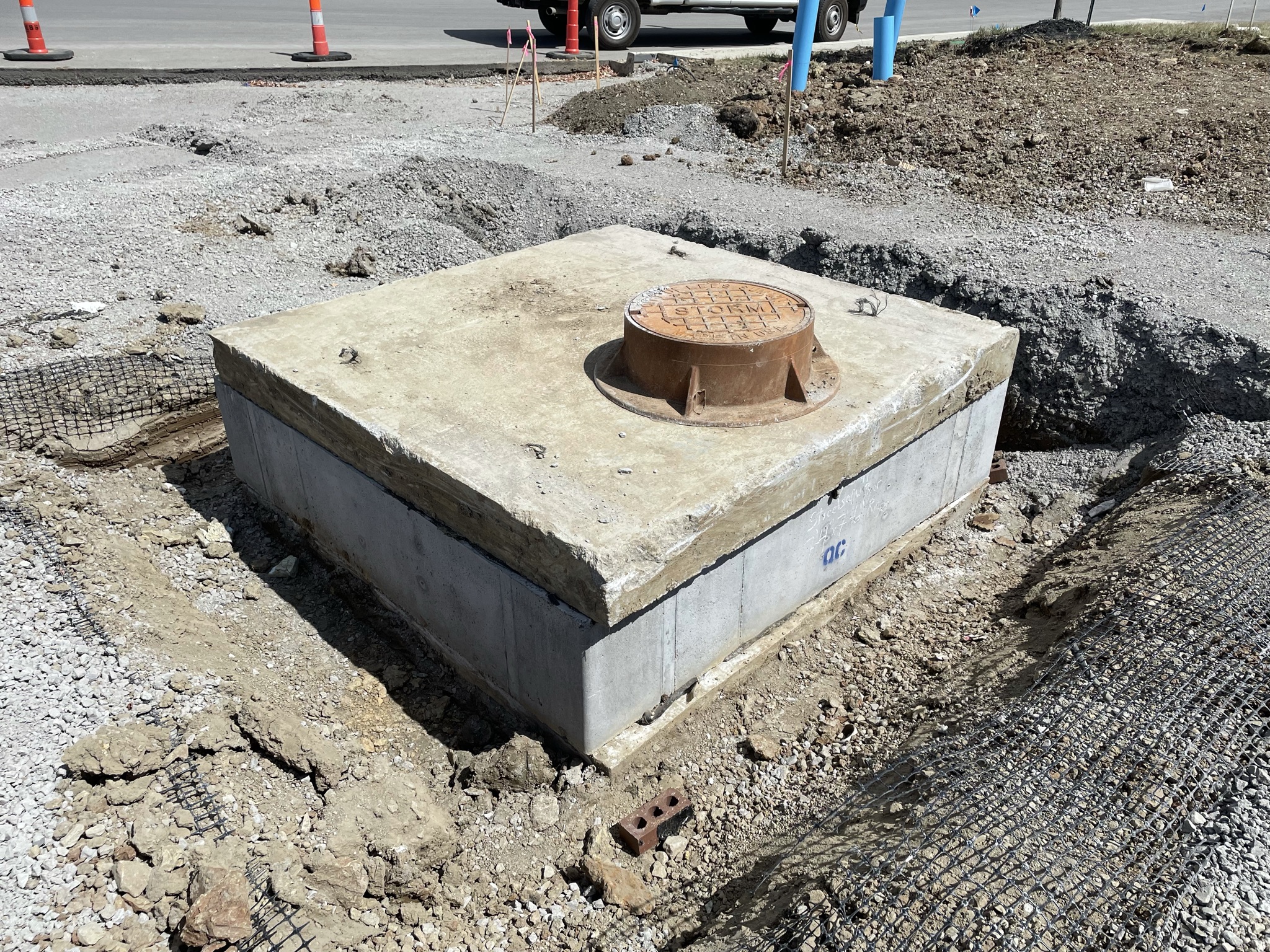

Storm Sewer Construction Inspection Partial 03/03/2022
Misc
Informational
03/03/2022
Chris from ESS set #4 bars every 12 inches while adjusting heights for the 3 field inlets. RP 3-3-22
Fire Line Construction Inspection Passed 3/4/2022 3/4/2022 03/04/2022
Misc
Informational
03/04/2022
Witnessed ESS flush the fire lines for 30 minutes for both apartment buildings #1 and #2. RP 3-4-22
Site Visit Partial 3/4/2022 3/4/2022 03/04/2022
Misc
Informational
02/24/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
02/24/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
02/24/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
02/24/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
03/04/2022
Witnessed the fire lines being flushed. RP 3-4-22
Erosion Control Inspection Partial 03/23/2022
Misc
Informational
03/23/2022
No erosion issues to report on the job site today. RP 3-23-22
Erosion Control Inspection Partial 03/24/2022
Misc
Informational
03/23/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
03/24/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Site Visit Partial 04/06/2022
Misc
Informational
03/04/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
03/04/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
03/04/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
03/04/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
03/04/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
04/06/2022
No utility work or grading being done today. RP 4-6-22
Site Visit Partial 4/11/2022 4/11/2022 04/18/2022
Misc
Informational
04/06/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
04/06/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
04/06/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
04/06/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
04/06/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
04/06/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/18/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Site Visit Partial 4/19/2022 4/19/2022 04/19/2022
Misc
Informational
04/18/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
04/18/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
04/18/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
04/18/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
04/18/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
04/18/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/18/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
04/19/2022

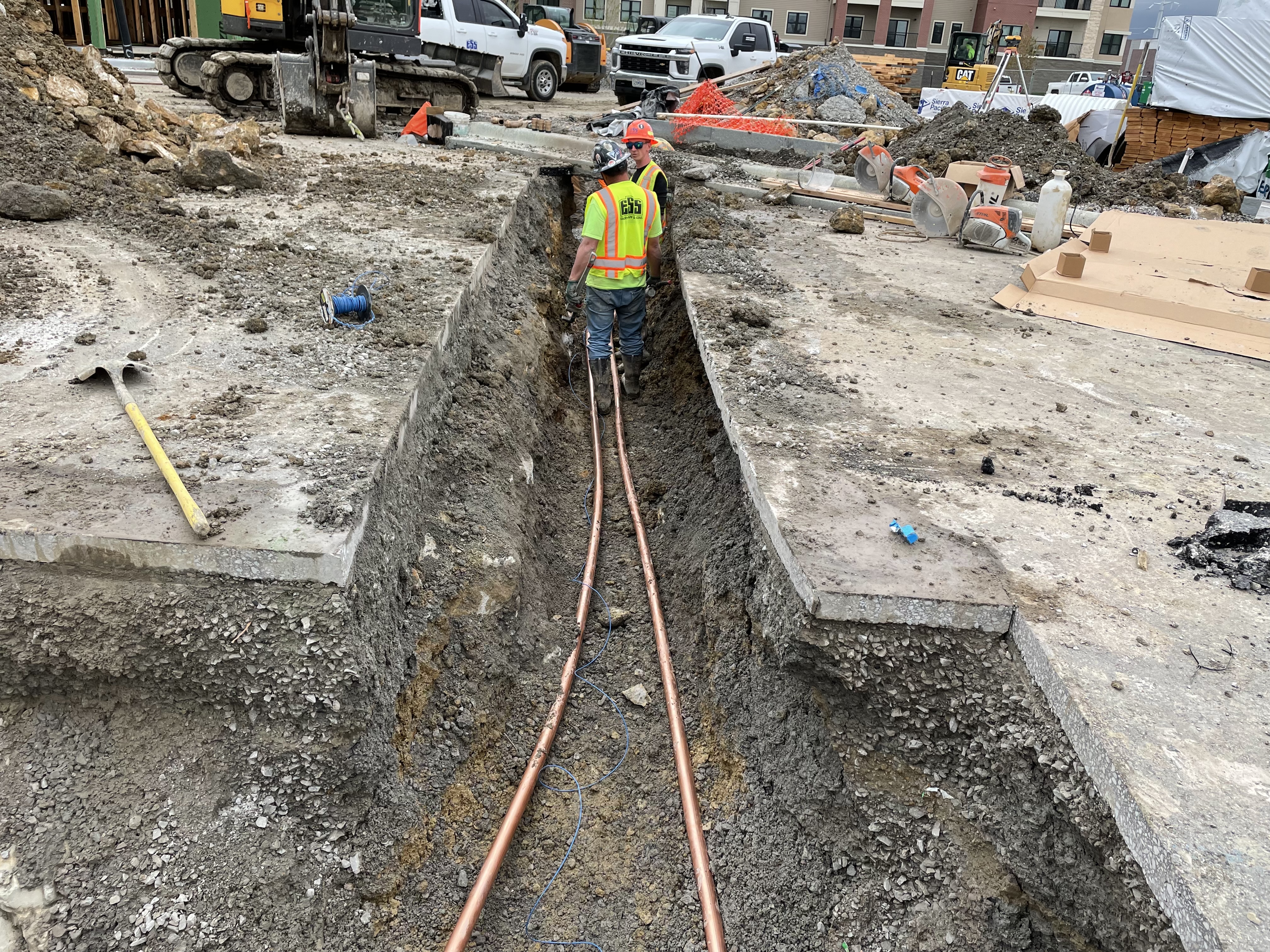

Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Water Service Inspection Partial 05/06/2022
Misc
Informational
05/06/2022

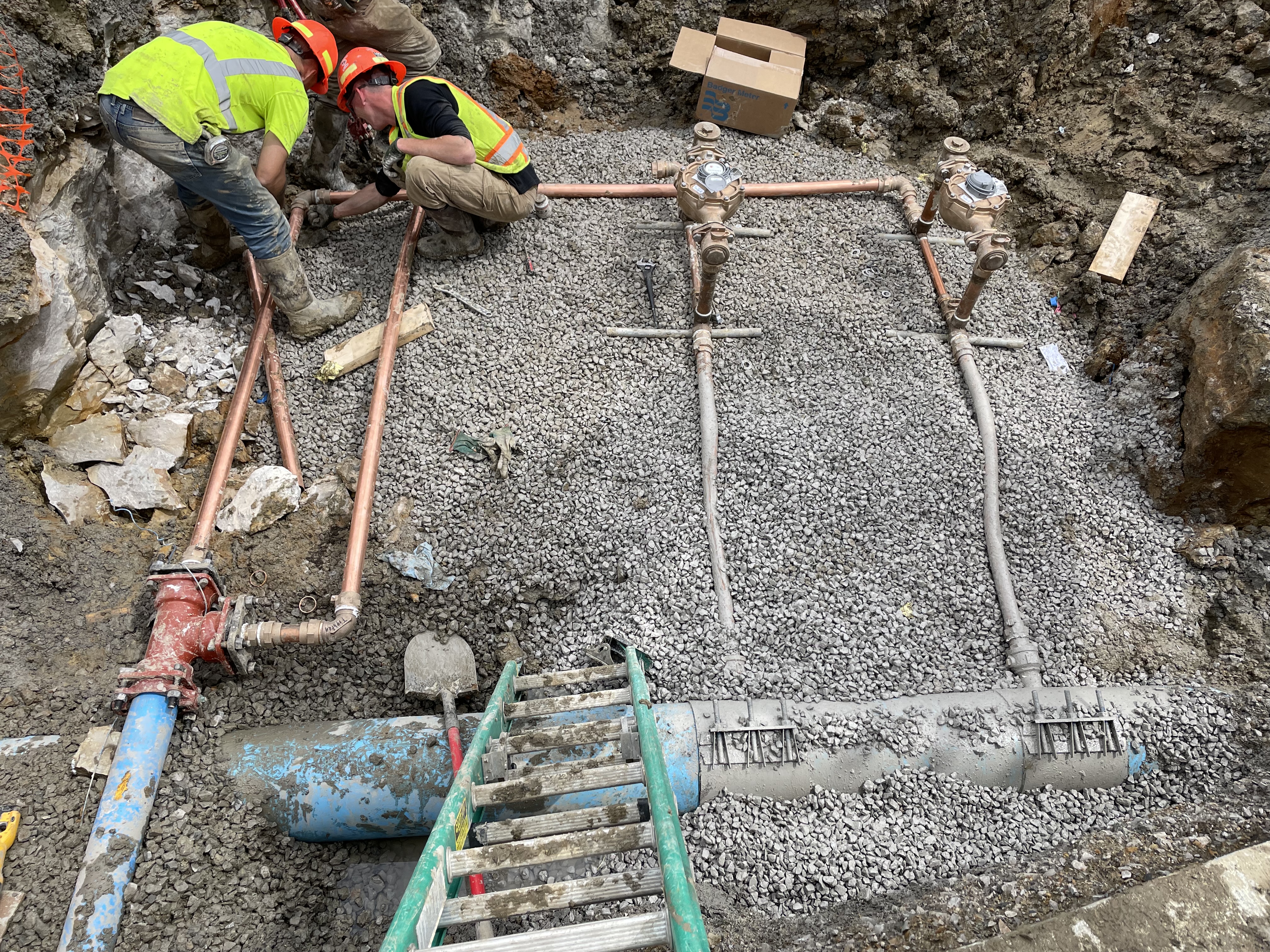

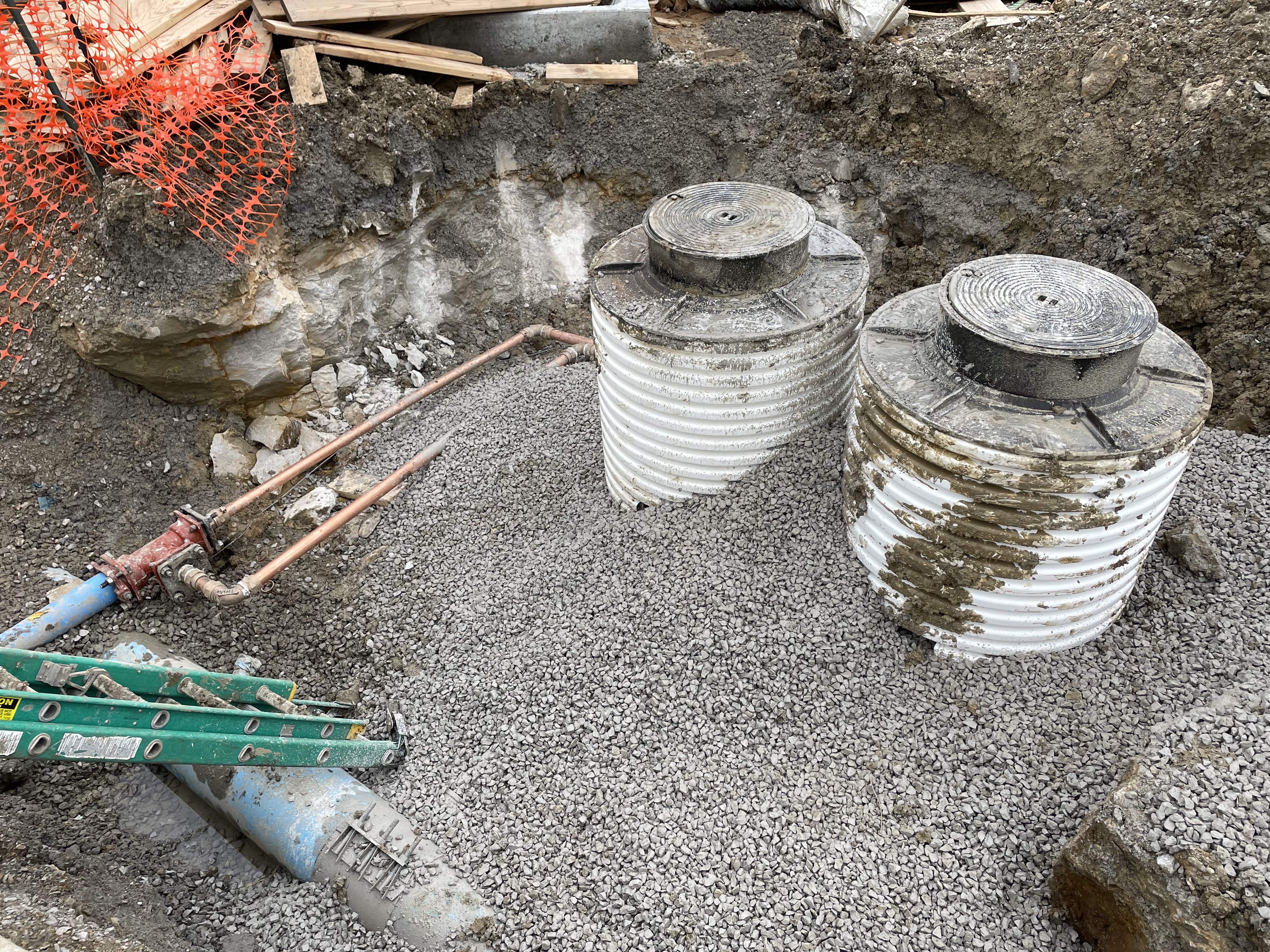

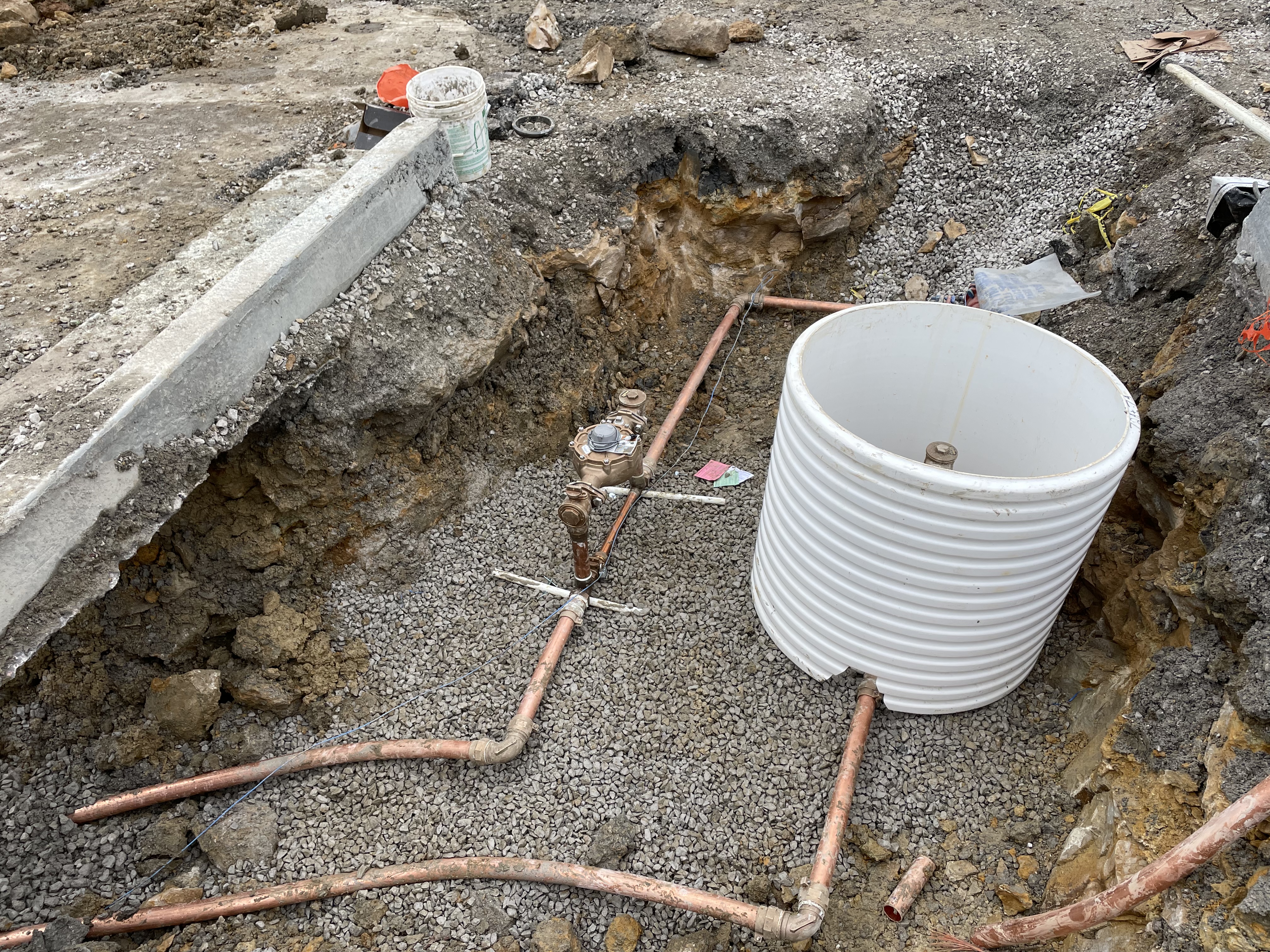

Tyler, Rudy and crew installed 4 - 2” service meters. 2 for each apartment complex. Then ran those 2 in lines into a 4” C900 line to run into building using all copper line and brass fittings from main to 4” Tee with reducers installed. 5/5/22 ES
Water Service Inspection Partial 05/23/2022
Misc
Informational
05/06/2022
Tyler, Rudy and crew installed 4 - 2” service meters. 2 for each apartment complex. Then ran those 2 in lines into a 4” C900 line to run into building using all copper line and brass fittings from main to 4” Tee with reducers installed. 5/5/22 ES Rudy’s crew removed 1” irrigation meter and assembly from Lot 7A area, and installed 2 new 1.5” irrigation taps on west side of apartments for apartments and villas. 5/20/22 ES
Site Visit Partial 05/23/2022
Misc
Informational
04/19/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
04/19/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
04/19/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
04/19/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
04/19/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
04/19/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/19/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
04/19/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
05/23/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES
Storm Sewer Construction Inspection Partial 5/20/2022 5/20/2022 05/25/2022
Misc
Informational
03/03/2022
Chris from ESS set #4 bars every 12 inches while adjusting heights for the 3 field inlets. RP 3-3-22
Misc
Informational
05/25/2022
Rudy’s crew was going to start on roof drains, but had limited access and issues with over poured footings. ESS will work on these at a later time when congestion and materials aren’t in the way. 5/19/22 ES
Site Visit Partial 05/31/2022
Misc
Informational
05/23/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
05/23/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
05/23/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
05/23/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
05/23/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
05/23/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
05/23/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
05/23/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
05/23/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES
Site Visit Partial 06/06/2022
Misc
Informational
05/31/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
05/31/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
05/31/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
05/31/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
05/31/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
05/31/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
05/31/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
05/31/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
05/31/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES
Site Visit Partial 06/08/2022
Misc
Informational
06/06/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/06/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/06/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/06/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/06/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/06/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/06/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/06/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/06/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES
Pavement-Aggregate Base Partial 06/08/2022
Misc
Informational
12/15/2021
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
12/15/2021
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
06/08/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES
Site Visit Partial 06/14/2022
Misc
Informational
06/08/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/08/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/08/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/08/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/08/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/08/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/08/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/08/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/08/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES
Pavement-Stabilized Subgrade Partial 06/16/2022
Misc
Informational
06/16/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES
Site Visit Partial 06/16/2022
Misc
Informational
06/14/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/14/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/14/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/14/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/14/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/14/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/14/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/14/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/14/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES
Pavement-Stabilized Subgrade Partial 06/20/2022
Misc
Informational
06/16/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES
Pavement-Proof Roll Partial 06/20/2022
Misc
Informational
12/21/2021
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
12/21/2021
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
12/21/2021
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
12/21/2021
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
06/20/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES
Pavement-Aggregate Base Partial 06/20/2022
Misc
Informational
06/08/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
06/08/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
06/08/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES
Pavement-Stabilized Subgrade Partial 06/20/2022
Misc
Informational
06/20/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES ESS began laying and compacting aggregate on stabilized sub grade today. 6/20/22 ES
Pavement-Aggregate Base Partial 06/20/2022
Misc
Informational
06/20/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
06/20/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
06/20/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES
Site Visit Partial 06/20/2022
Misc
Informational
06/16/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/16/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/16/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/16/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/16/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/16/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/16/2022

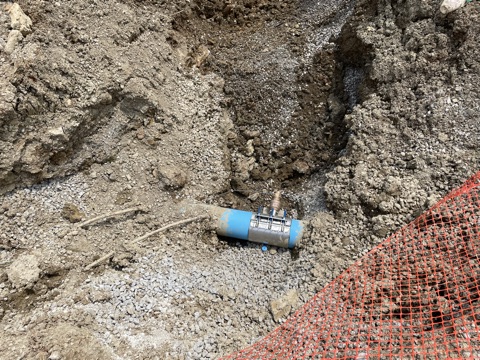

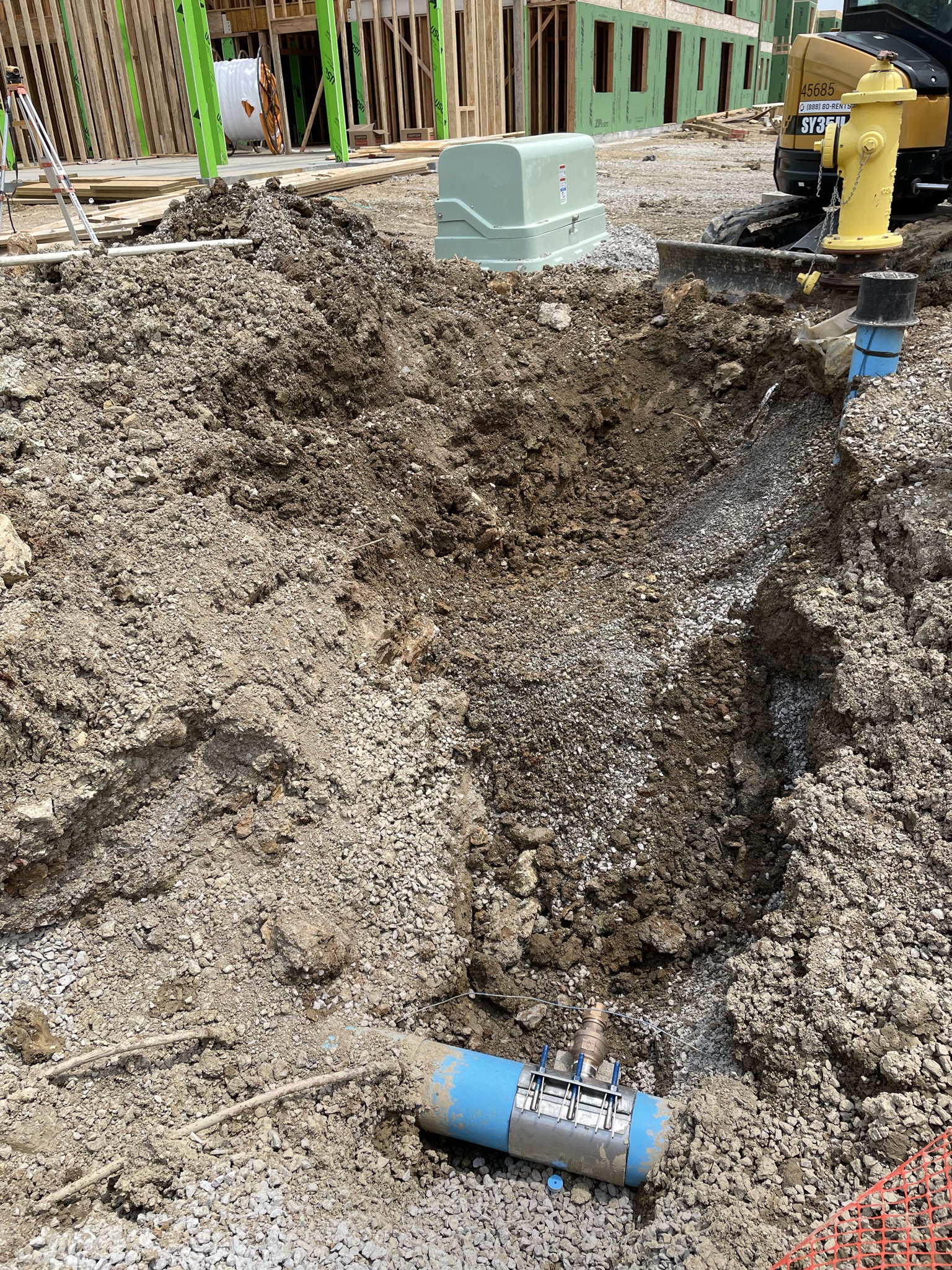

Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/16/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/16/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES
Site Visit Partial 06/20/2022
Misc
Informational
06/20/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/20/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/20/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/20/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/20/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/20/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/20/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/20/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Pavement-Curb Construction Partial 06/20/2022
Misc
Informational
12/22/2021
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
12/22/2021
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
12/22/2021
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
12/22/2021
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
06/20/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES
Pavement-Curb Construction Partial 07/13/2022
Misc
Informational
06/20/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
06/20/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
06/20/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
06/20/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
06/20/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES
Pavement-Curb Construction Partial 07/13/2022
Misc
Informational
07/13/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
07/13/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
07/13/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
07/13/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
07/13/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES
Pavement-Curb Construction Partial 07/14/2022
Misc
Informational
07/13/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
07/13/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
07/13/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
07/13/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
07/13/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES
Pavement-Curb Construction Partial 07/14/2022
Misc
Informational
07/14/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
07/14/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
07/14/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
07/14/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
07/14/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES
Pavement-Curb Construction Partial 07/15/2022
Misc
Informational
07/14/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
07/14/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
07/14/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
07/14/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
07/14/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES

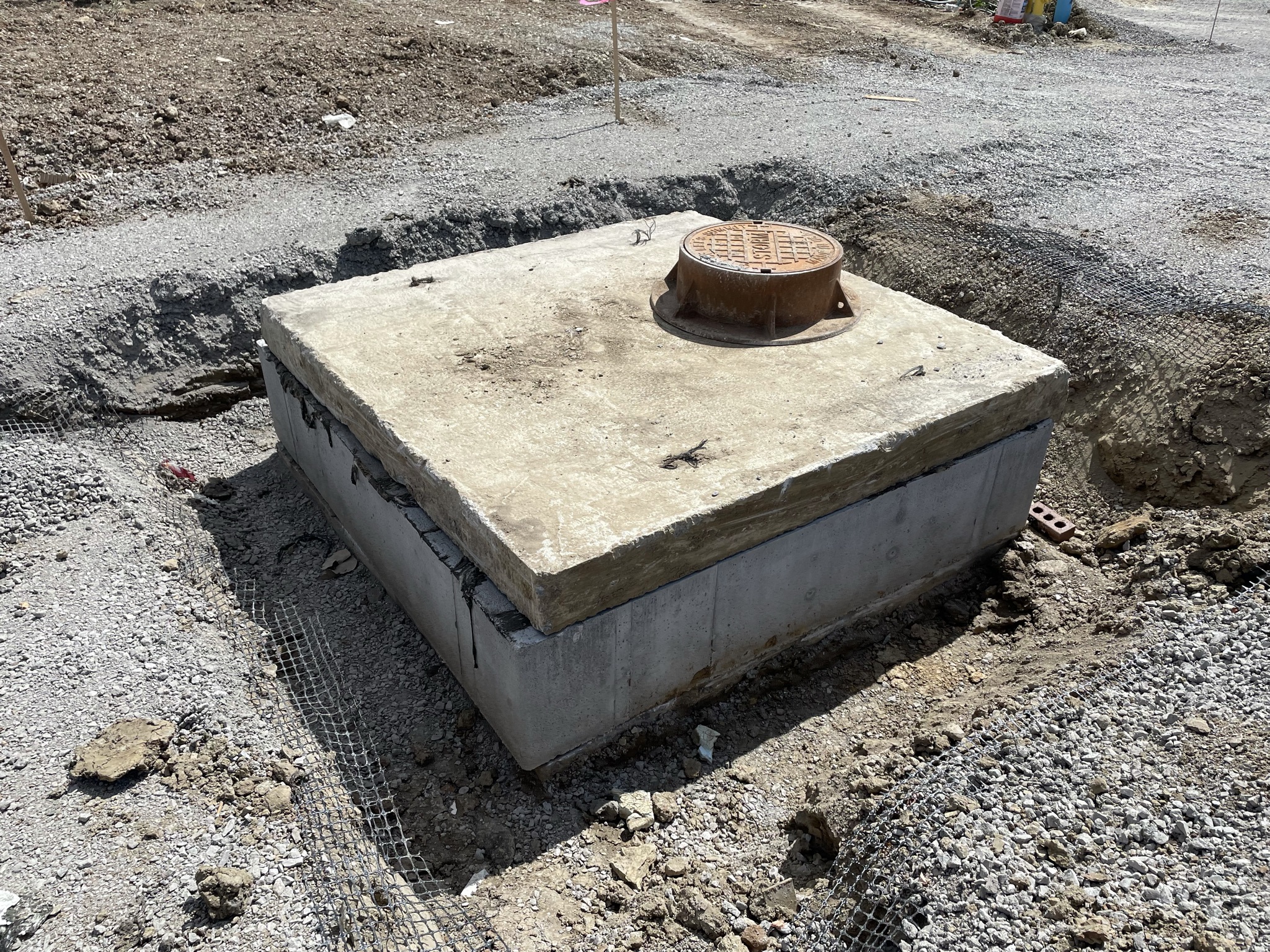

Grading/Excavation/Fill Inspection Partial 07/15/2022
Misc
Informational
07/15/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES
Grading/Excavation/Fill Inspection Partial 07/16/2022
Misc
Informational
07/15/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES
Pavement-Aggregate Base Partial 07/16/2022
Misc
Informational
06/20/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
06/20/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
06/20/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES
Pavement-Proof Roll Partial 07/16/2022
Misc
Informational
06/20/2022
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
06/20/2022
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
06/20/2022
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
06/20/2022
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
06/20/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES
Pavement-Surface Partial 1/23/2022 07/16/2022
Misc
Informational
12/23/2021
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
12/23/2021
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
07/16/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES
Site Visit Partial 07/18/2022
Misc
Informational
06/20/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
06/20/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
06/20/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
06/20/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
06/20/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
06/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/20/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
06/20/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
06/20/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
07/18/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES
Site Visit Partial 07/19/2022
Misc
Informational
07/18/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
07/18/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
07/18/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
07/18/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
07/18/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
07/18/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/18/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
07/18/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
07/18/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
07/18/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES
Grading/Excavation/Fill Inspection Partial 07/19/2022
Misc
Informational
07/16/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES
Pavement-Stabilized Subgrade Partial 07/19/2022
Misc
Informational
06/20/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES ESS began laying and compacting aggregate on stabilized sub grade today. 6/20/22 ES Seal-O-Matic doing sub base stabilization. 7/19/22 ES
Grading/Excavation/Fill Inspection Partial 07/19/2022
Misc
Informational
07/19/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES
Pavement-Aggregate Base Partial 07/20/2022
Misc
Informational
07/16/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
07/16/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
07/16/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES
Grading/Excavation/Fill Inspection Partial 07/20/2022
Misc
Informational
07/19/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES
Pavement-Stabilized Subgrade Partial 07/20/2022
Misc
Informational
07/19/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES ESS began laying and compacting aggregate on stabilized sub grade today. 6/20/22 ES Seal-O-Matic doing sub base stabilization. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for base. ESS working on cutting grade. Will proof roll 7/21 pm. 7/20/22 ES
Pavement-Proof Roll Partial 07/20/2022
Misc
Informational
07/16/2022
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
07/16/2022
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
07/16/2022
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
07/16/2022
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
07/16/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES ESS cutting grade on south parking lot of apartments. Will do proof roll 7/21 pm. 7/20/22 ES
Pavement-Surface Partial 07/20/2022
Misc
Informational
07/16/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
07/16/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
07/16/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES
Pavement-Surface Partial 07/21/2022
Misc
Informational
07/20/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
07/20/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
07/20/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES
Grading/Excavation/Fill Inspection Partial 07/21/2022
Misc
Informational
07/20/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES
Pavement-Proof Roll Partial 7/21/2022 (2:00) 7/21/2022 07/21/2022
Misc
Informational
07/20/2022
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
07/20/2022
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
07/20/2022
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
07/20/2022
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
07/20/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES ESS cutting grade on south parking lot of apartments. Will do proof roll 7/21 pm. 7/20/22 ES ESS performed proof roll on stabilized sub base with 19.91 ton load. Passed. 7/21/22 ES
Pavement-Aggregate Base Partial 07/22/2022
Misc
Informational
07/20/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
07/20/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
07/20/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES ESS performed a proof roll on south apt parking lot with 19.91 ton load. 7/21/22 ES
Roof Drain Partial 07/26/2022
Misc
Informational
07/26/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES
Roof Drain Partial 07/26/2022
Misc
Informational
07/26/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES
Site Visit Partial 07/26/2022
Misc
Informational
07/19/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
07/19/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
07/19/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
07/19/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
07/19/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
07/19/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/19/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
07/19/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
07/19/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
07/19/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES
Pavement-Aggregate Base Partial 07/26/2022
Misc
Informational
07/22/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
07/22/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
07/22/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES ESS performed a proof roll on south apt parking lot with 19.91 ton load. 7/21/22 ES ESS laying aggregate base down on South parking lot. 7/22/22 ES
Erosion Control Inspection Partial 07/26/2022
Misc
Informational
03/24/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
03/24/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
07/26/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES
Grading/Excavation/Fill Inspection Partial 07/26/2022
Misc
Informational
07/21/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES
Pavement-Aggregate Base Partial 07/26/2022
Misc
Informational
07/26/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
07/26/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
07/26/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES ESS performed a proof roll on south apt parking lot with 19.91 ton load. 7/21/22 ES ESS laying aggregate base down on South parking lot. 7/22/22 ES ESS grading aggregate base on South parking lot. 7/26/22 ES
Pavement-Stabilized Subgrade Partial 07/26/2022
Misc
Informational
07/20/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES ESS began laying and compacting aggregate on stabilized sub grade today. 6/20/22 ES Seal-O-Matic doing sub base stabilization. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for base. ESS working on cutting grade. Will proof roll 7/21 pm. 7/20/22 ES Proof rolled with 19.91 ton load. Passed. 7/21/22 ES
Grading/Excavation/Fill Inspection Partial 08/01/2022
Misc
Informational
07/26/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES
Grading/Excavation/Fill Inspection Partial 08/01/2022
Misc
Informational
08/01/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES Performed proof roll with 20.10 ton load. Passed. 8/1/22 ES
Erosion Control Inspection Partial 08/01/2022
Misc
Informational
07/26/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
07/26/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
07/26/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES
Pavement-Proof Roll Partial 08/01/2022
Misc
Informational
07/21/2022
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
07/21/2022
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
07/21/2022
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
07/21/2022
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
07/21/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES ESS cutting grade on south parking lot of apartments. Will do proof roll 7/21 pm. 7/20/22 ES ESS performed proof roll on stabilized sub base with 19.91 ton load. Passed. 7/21/22 ES Performed proof roll for curbs with a 20.10 ton load. Passed 8/1/22 ES
Pavement-Curb Construction Partial 08/01/2022
Misc
Informational
07/15/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
07/15/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
07/15/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
07/15/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
07/15/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES
Pavement-Aggregate Base Partial 08/01/2022
Misc
Informational
07/26/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
07/26/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
07/26/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES ESS performed a proof roll on south apt parking lot with 19.91 ton load. 7/21/22 ES ESS laying aggregate base down on South parking lot. 7/22/22 ES ESS grading aggregate base on South parking lot. 7/26/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES
Pavement-Stabilized Subgrade Passed 08/01/2022
Misc
Informational
07/26/2022
They laid down 12 inches of Portland Cement at 6% moisture for Black Twig. RP 12-13-21 Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and parking lot behind northern apartment. CFS was onsite doing compaction testing. Initial tests were coming back at all above 96% compaction and 6% moisture content. 6/16/22 ES Performed proof roll on parking lot on north side of apartments. Passed. 6/17/22 ES ESS began laying and compacting aggregate on stabilized sub grade today. 6/20/22 ES Seal-O-Matic doing sub base stabilization. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for base. ESS working on cutting grade. Will proof roll 7/21 pm. 7/20/22 ES Proof rolled with 19.91 ton load. Passed. 7/21/22 ES Performed proof roll for curbs with a 20.10 ton load. Passed 8/1/22 ES
Roof Drain Partial 08/01/2022
Misc
Informational
07/26/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES Steve’s crew working on roof drains on South side of building 2. 7/30/22 ES
Roof Drain Partial 08/02/2022
Misc
Informational
08/01/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES Steve’s crew working on roof drains on South side of building 2. 7/30/22 ES Steve’s crew working on roof drains on North side of Building 1. 8/1/22 ES
Roof Drain Partial 08/02/2022
Misc
Informational
08/02/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES Steve’s crew working on roof drains on South side of building 2. 7/30/22 ES Steve’s crew working on roof drains on North side of Building 1. 8/1/22 ES Steve’s crew working on roof drains on north side of bldg 1. 8/2/22 ES
Roof Drain Partial 08/03/2022
Misc
Informational
08/02/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES Steve’s crew working on roof drains on South side of building 2. 7/30/22 ES Steve’s crew working on roof drains on North side of Building 1. 8/1/22 ES Steve’s crew working on roof drains on north side of bldg 1. 8/2/22 ES Steve’s crew working on roof drains on north/east side of bldg 1. 8/3/22 ES
Site Visit Partial 08/04/2022
Misc
Informational
07/26/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
07/26/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
07/26/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
07/26/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
07/26/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
07/26/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/26/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
07/26/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
07/26/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
07/26/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES
Erosion Control Inspection Partial 08/08/2022
Misc
Informational
08/01/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/01/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/01/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES
Grading/Excavation/Fill Inspection Partial 08/08/2022
Misc
Informational
08/01/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES Performed proof roll with 20.10 ton load. Passed. 8/1/22 ES
Site Visit Partial 08/10/2022
Misc
Informational
08/04/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
08/04/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
08/04/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
08/04/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
08/04/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
08/04/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/04/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
08/04/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
08/04/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
08/04/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES
Site Visit Partial 08/11/2022
Misc
Informational
08/10/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
08/10/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
08/10/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
08/10/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
08/10/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
08/10/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/10/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
08/10/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
08/10/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
08/10/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES
Site Visit Partial 08/11/2022
Misc
Informational
08/11/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
08/11/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
08/11/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
08/11/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
08/11/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
08/11/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/11/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
08/11/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
08/11/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
08/11/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES
Site Visit Partial 08/17/2022
Misc
Informational
08/11/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
08/11/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
08/11/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
08/11/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
08/11/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
08/11/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/11/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
08/11/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
08/11/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
08/11/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES No Utility work being done due to rain. 8/16/22 ES
Pavement-Curb Construction Partial 08/17/2022
Misc
Informational
08/01/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
08/01/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
08/01/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
08/01/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
08/01/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Epic concrete poured straight line curbs using KCMMB mix and curb machine. 8/15/22 ES
Pavement-Curb Construction Partial 08/17/2022
Misc
Informational
08/17/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
08/17/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
08/17/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
08/17/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
08/17/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Epic concrete poured straight line curbs using KCMMB mix and curb machine. 8/15/22 ES Epic concrete onsite setting up forms for radius and other hand pours. 8/17/22 ES
Pavement-Curb Construction Partial 08/23/2022
Misc
Informational
08/17/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
08/17/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
08/17/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
08/17/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
08/17/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Epic concrete poured straight line curbs using KCMMB mix and curb machine. 8/15/22 ES Epic concrete onsite setting up forms for radius and other hand pours. 8/17/22 ES Epic concrete poured curbs on South parking lot. 8/17-8/19 ES
Pavement-Curb Construction Partial 08/23/2022
Misc
Informational
08/23/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
08/23/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
08/23/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
08/23/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
08/23/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Epic concrete poured straight line curbs using KCMMB mix and curb machine. 8/15/22 ES Epic concrete onsite setting up forms for radius and other hand pours. 8/17/22 ES Epic concrete poured curbs on South parking lot. 8/17-8/19 ES Epic concrete finished hand pouring sections and radius portions of curbing. 8/22/22 ES
Erosion Control Inspection Partial 08/23/2022
Misc
Informational
08/08/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/08/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/08/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES
Sanitary Sewer Construction Inspection Passed 08/23/2022
Misc
Informational
08/23/2022
Sanitary Sewer inspections completed under permit #2021 5386. ES
Erosion Control Inspection Partial 08/29/2022
Misc
Informational
08/23/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/23/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/23/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES
Pavement-Proof Roll Passed 08/29/2022
Misc
Informational
08/01/2022
They had a tandem dump truck with a 20.12 ton load. We proof rolled the chemical stabilization on Black Twig. The sub-grade was solid enough for them to start laying base rock. RP 12-14-21
Misc
Informational
08/01/2022
They had a tandem dump truck with a 29.59 ton load. We proof rolled the parking lot subgrade. The northern edge was the only area that failed. The were going to rework that section and add some extra rock. RP 12-14-21
Misc
Informational
08/01/2022
They had a tandem dump truck with a 19.63 ton load. We proof rolled the curb line for both parking lots and Black Twig. A majority of the subgrade was solid. The few areas in question, they will rework the area with additional rock. RP 12-15-21
Misc
Informational
08/01/2022
They had a tandem dump truck with a 19.7 ton load. Black Twig and the parking lots passed the proof roll for laying base asphalt. RP 12-21-21
Misc
Informational
08/01/2022
Performed proof roll; with 20.12 ton load, on parking lot on north side of apartments and Black Twig Cir. All areas were solid and passed. 6/17/22 ES Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES ESS cutting grade on south parking lot of apartments. Will do proof roll 7/21 pm. 7/20/22 ES ESS performed proof roll on stabilized sub base with 19.91 ton load. Passed. 7/21/22 ES Performed proof roll for curbs with a 20.10 ton load. Passed 8/1/22 ES Performed proof roll for asphalt base with a 19.69 ton load of rock. Passed 8/25/22 ES
Pavement-Aggregate Base Passed 08/29/2022
Misc
Informational
08/01/2022
They laid over 1,000 tons AB3 6 inches thick for Black Twig. RP 12-14-21
Misc
Informational
08/01/2022
They laid 6 inches of AB3 for building #2 parking lot. RP 12-15-21
Misc
Informational
08/01/2022
Spoke with Cody this morning. They plan on starting on the sub grade stabilization on Black Twig Cir early next week. 6/8/22 ES Sub grade stabilization pass proof roll, ready to begin aggregate layer. 6/17/22 ES EES began laying and compacting aggregate. 6/20/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES Seal-O-Matic laying 3” of Type 2 base asphalt on Black Twig and North parking lot. 7/20/22 ES ESS performed a proof roll on south apt parking lot with 19.91 ton load. 7/21/22 ES ESS laying aggregate base down on South parking lot. 7/22/22 ES ESS grading aggregate base on South parking lot. 7/26/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Performed proof roll on South parking lot for asphalt base with a 19.69 ton load. Passed 8/25/22 ES
Pavement-Curb Construction Passed 08/29/2022
Misc
Informational
08/23/2022
Richard’s crew from ESS laid over 60 yards of KCMMB mix for Black Twig. RP 12-16-21
Misc
Informational
08/23/2022
Richard’s crew hand poured all radius’s and curb inlets except for 1 that has the wrong top. Everything is covered with blankets until concrete passes strength test. RP 12-17-21
Misc
Informational
08/23/2022
Epic Concrete poured 70 cubic yards of 5K KCMMB mix for 0ver 1400 feet of curbing. CSN was on site doing testing. Curbs were covered with blankets until they pass strength testing. RP 12-20-21
Misc
Informational
08/23/2022
Epic laid another 60 cubic yards of 5K KCMMB mix for curbing radius’s Mike Simpson was on site making cylinders and doing testing. RP 12-22-21
Misc
Informational
08/23/2022
ESS laying base aggregate for curbs and roadway. 6/20/22 ES Epic Concrete on site laying curb. 7/12/22 ES Epic Concrete pouring curbs. 7/13/22 ES Epic Concrete working on finishing curbs and radiuses. 7/14/22 ES Spoke with Codi, they will be looking to proof roll this section on 7/15/22 and look to potentially start paving on 7/16. 7/14/22 ES Curbs are finished and ESS was working on backfilling behind curbs. 7/15/22 ES Performed proof roll on South parking lot for curbs with a 20.10 ton load. Passed 8/1/22 ES Epic concrete poured straight line curbs using KCMMB mix and curb machine. 8/15/22 ES Epic concrete onsite setting up forms for radius and other hand pours. 8/17/22 ES Epic concrete poured curbs on South parking lot. 8/17-8/19 ES Epic concrete finished hand pouring sections and radius portions of curbing. 8/22/22 ES
Pavement-Surface Partial 08/29/2022
Misc
Informational
07/21/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
07/21/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
07/21/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES
Sanitary Sewer - Camera Test Passed 9/22/2022 08/29/2022
Misc
Informational
08/29/2022
Public portion of sewer was inspection completed by water. Ace Pipe cleaning flushed lines 8/20/22…. 8/29/22 ES
Pavement-Surface Partial 08/30/2022
Misc
Informational
08/29/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
08/29/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
08/29/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES
Erosion Control Inspection Partial 09/08/2022
Misc
Informational
08/29/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/29/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/29/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES
Pavement-Curb Construction Partial 09/08/2022
Misc
Informational
09/08/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES
Pavement-Curb Construction Partial 09/08/2022
Misc
Informational
09/08/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES ESS finished ripping out curb and recompacted subgrade in preparation for curbs. 9/7/22 ES
Pavement-Curb Construction Partial 09/08/2022
Misc
Informational
09/08/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES ESS finished ripping out curb and recompacted subgrade in preparation for curbs. 9/7/22 ES JD Bishop Concrete poured lazy back curbs using KCMMB 4k mix in all areas in front of bldg 1-3. 9/8/22 ES
Sidewalk Inspection Partial 09/08/2022
Misc
Informational
09/08/2022
JD Bishop began pouring sections of sidewalk along Lowenstein Dr. 9/8/22 ES
Sidewalk Inspection Partial 09/09/2022
Misc
Informational
09/08/2022
JD Bishop began pouring sections of sidewalk along Lowenstein Dr. 9/8/22 ES JD Bishop continues pouring sections of sidewalk using KCMMB 4K along Lowenstein Dr. 9/9/22 ES
Sidewalk Inspection Partial 09/15/2022
Misc
Informational
09/09/2022
JD Bishop began pouring sections of sidewalk along Lowenstein Dr. 9/8/22 ES JD Bishop continues pouring sections of sidewalk using KCMMB 4K along Lowenstein Dr. 9/9/22 ES JD Bishop working on sidewalks along Lowenstein Dr. 9/13/22 ES
Grading/Excavation/Fill Inspection Partial 09/16/2022
Misc
Informational
08/08/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES Performed proof roll with 20.10 ton load. Passed. 8/1/22 ES ESS backfilling along sidewalks on Lowenstein Dr. 9/16/22 ES
Pavement-Surface Partial 09/27/2022
Misc
Informational
08/30/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
08/30/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
08/30/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES
Pavement-Surface Partial 09/27/2022
Misc
Informational
09/27/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
09/27/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
09/27/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES
Erosion Control Inspection Partial 09/27/2022
Misc
Informational
09/08/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
09/08/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
09/08/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES
ESC - (Vegetation/Ground Cover) Partial 09/27/2022
Misc
Informational
09/27/2022
Vegetation not yet established. 9/26/22 ES
Grading/Excavation/Fill Inspection Partial 09/27/2022
Misc
Informational
09/16/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES Performed proof roll with 20.10 ton load. Passed. 8/1/22 ES ESS backfilling along sidewalks on Lowenstein Dr. 9/16/22 ES Areas along parking lot and sidewalks has all been backfilled on southern edge of Lot 7A. 9/26/22 ES
Site Visit Partial 09/27/2022
Misc
Informational
08/17/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
08/17/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
08/17/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
08/17/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
08/17/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
08/17/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/17/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
08/17/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
08/17/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
08/17/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES No Utility work being done due to rain. 8/16/22 ES Construction continues on apartments, Epic concrete repairing damaged curbing and ESS working on tearing out damaged asphalt base areas. 9/27/22 ES
Pavement-Curb Construction Partial 09/28/2022
Misc
Informational
09/08/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES ESS finished ripping out curb and recompacted subgrade in preparation for curbs. 9/7/22 ES JD Bishop Concrete poured lazy back curbs using KCMMB 4k mix in all areas in front of bldg 1-3. 9/8/22 ES Epic concrete onsite ripping out and replacing curbs for interior courtyard of apartments. 9/28/22 ES
Pavement-Surface Partial 09/28/2022
Misc
Informational
09/27/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
09/27/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
09/27/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES
Sanitary Sewer - Vacuum Partial 09/28/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Sanitary Sewer - Mandrel Partial 09/28/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Sanitary Sewer - Air Test Partial 09/28/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Pavement-Curb Construction Partial 09/30/2022
Misc
Informational
09/28/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES ESS finished ripping out curb and recompacted subgrade in preparation for curbs. 9/7/22 ES JD Bishop Concrete poured lazy back curbs using KCMMB 4k mix in all areas in front of bldg 1-3. 9/8/22 ES Epic concrete onsite ripping out and replacing curbs for interior courtyard of apartments. 9/28/22 ES Epic concrete onsite pouring new sections of curbs for interior courtyard of apartments. 9/30/22 ES
Erosion Control Inspection Partial 10/03/2022
Misc
Informational
09/27/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
09/27/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
09/27/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/03/2022
Misc
Informational
09/27/2022
Vegetation not yet established. 9/26/22 ES Vegetation not yet established. 10/3/22 ES
Pavement-Surface Partial 10/04/2022
Misc
Informational
09/28/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
09/28/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
09/28/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES
Sanitary Sewer - Air Test Passed 10/04/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Sanitary Sewer - Mandrel Passed 10/04/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Sanitary Sewer - Vacuum Passed 10/04/2022
Misc
Informational
09/28/2022
Public portion of sewer had inspection completed by water utilities. Inspections of public infrastructure performed under permit #2021 5386.. 9/28/22 ES
Site Visit Partial 10/05/2022
Misc
Informational
09/27/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
09/27/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
09/27/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
09/27/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
09/27/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
09/27/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
09/27/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
09/27/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
09/27/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
09/27/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES No Utility work being done due to rain. 8/16/22 ES Construction continues on apartments, Epic concrete repairing damaged curbing and ESS working on tearing out damaged asphalt base areas. 9/27/22 ES ESS continued sweeping and flushing North parking lot in preps for paving. 10/5/22am ES
Pavement-Surface Partial 10/06/2022
Misc
Informational
10/05/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
10/05/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
10/05/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES
Pavement-Surface Partial 10/06/2022
Misc
Informational
10/04/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
10/04/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
10/04/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES ESS was working on cleaning north parking lot of apartments still. 10/6/22 ES
Pavement-Surface Partial 10/07/2022
Misc
Informational
10/06/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
10/06/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
10/06/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES Seal-O-Matic finished laying type 3R asphalt in apartment courtyard as well at north parking lot. Mike from CFS was onsite testing compaction rates. 10/7/22 ES
Street - Striping Partial 10/07/2022
Misc
Informational
10/07/2022
Spoke with Mike from Brinkmann, they will be striping the parking stalls and interior courtyard parking areas on Monday 10/10.. 10/7/22 ES
Erosion Control Inspection Partial 10/11/2022
Misc
Informational
10/03/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/03/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/03/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES
Street - Striping Partial 10/10/2022 10/10/2022 10/11/2022
Misc
Informational
10/07/2022
Spoke with Mike from Brinkmann, they will be striping the parking stalls and interior courtyard parking areas on Monday 10/10.. 10/7/22 ES K&G Striping was onsite today striping North parking lot and apartment courtyard parking today. 10/10/22 ES
Erosion Control Inspection Partial 10/11/2022
Misc
Informational
10/11/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/11/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/11/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Had an issue called in about mud and tracks coming from entrances near lots 11/12 and going along north side and behind existing apartments. Appears some construction traffic used these entrances unnecessarily. Spoke with Mike with Brinkmann, he was able to mobilize a sweeper and get these areas cleaned up and under control. 10/11/22 ES
Site Visit Partial 10/14/2022
Misc
Informational
10/05/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
10/05/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
10/05/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
10/05/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
10/05/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
10/05/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
10/05/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
10/05/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
10/05/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
10/05/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES No Utility work being done due to rain. 8/16/22 ES Construction continues on apartments, Epic concrete repairing damaged curbing and ESS working on tearing out damaged asphalt base areas. 9/27/22 ES ESS continued sweeping and flushing North parking lot in preps for paving. 10/5/22am ES No utility work requiring inspection being completed. 10/14/22 ES
Erosion Control Inspection Partial 10/19/2022
Misc
Informational
10/11/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/11/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/11/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Had an issue called in about mud and tracks coming from entrances near lots 11/12 and going along north side and behind existing apartments. Appears some construction traffic used these entrances unnecessarily. Spoke with Mike with Brinkmann, he was able to mobilize a sweeper and get these areas cleaned up and under control. 10/11/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES
Sidewalk Inspection Partial 10/20/2022
Misc
Informational
09/15/2022
JD Bishop began pouring sections of sidewalk along Lowenstein Dr. 9/8/22 ES JD Bishop continues pouring sections of sidewalk using KCMMB 4K along Lowenstein Dr. 9/9/22 ES JD Bishop working on sidewalks along Lowenstein Dr. 9/13/22 ES Epic concrete was onsite framing up for sidewalks on western edge of apartment buildings. Sidewalks were framed up with aggregate in and compacted. 10/19/22 ES Epic concrete was onsite pouring sidewalks and framing up more sidewalks along the western edge of apartments. Sidewalks were framed up with aggregate in and compacted. 10/20/22 ES
Erosion Control Inspection Partial 11/08/2022
Misc
Informational
10/19/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/19/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/19/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Had an issue called in about mud and tracks coming from entrances near lots 11/12 and going along north side and behind existing apartments. Appears some construction traffic used these entrances unnecessarily. Spoke with Mike with Brinkmann, he was able to mobilize a sweeper and get these areas cleaned up and under control. 10/11/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Erosion control measures installed, intact, and functioning. 11/7/22 ES
Pavement-Surface Partial 11/08/2022
Misc
Informational
10/07/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
10/07/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
10/07/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES Seal-O-Matic finished laying type 3R asphalt in apartment courtyard as well at north parking lot. Mike from CFS was onsite testing compaction rates. 10/7/22 ES Seal-O-Matic finished laying surface layer of asphalt on southern apartment parking lot. Used Type 3R asphalt. 11/7/22 ES
ESC - (Vegetation/Ground Cover) Partial 11/18/2022
Misc
Informational
10/03/2022
Vegetation not yet established. 9/26/22 ES Vegetation not yet established. 10/3/22 ES Vegetation yet to be established. 11/18/22 ES
Erosion Control Inspection Partial 11/18/2022
Misc
Informational
11/08/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
11/08/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
11/08/2022
Rainy day, some mud along roadways on the interior portion of apartments. 7/25/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/1/22 ES Erosion control measures still installed and functioning along outer edges of project. 8/8/22 ES Erosion controls installed and containing issues within worksite perimeter. 8/22/22 ES Erosion controls installed and containing any issues within perimeter. 8/29/22 ES Erosion controls installed, intact, and functioning. 9/8/22 ES Erosion control measures installed, intact, and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Had an issue called in about mud and tracks coming from entrances near lots 11/12 and going along north side and behind existing apartments. Appears some construction traffic used these entrances unnecessarily. Spoke with Mike with Brinkmann, he was able to mobilize a sweeper and get these areas cleaned up and under control. 10/11/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Erosion control measures installed, intact, and functioning. 11/7/22 ES Erosion control measures install, intact and functioning. 11/18/22 ES
Grading/Excavation/Fill Inspection Partial 11/18/2022
Misc
Informational
09/27/2022
ESS backfilling curbs and final grading on parking lot area. 7/15/22 ES Performed proof roll with ESS and CFS 20.24 ton load. 7/16/22 ES ESS grading along south parking lot of apartments. 7/18/22 ES Seal-O-Matic doing sub base stabilization and ESS continues working on grade on south parking lot of apartments. 7/19/22 ES Seal-O-Matic finished tilling in cement treatment for sub base, ESS working on grading. 7/20/22 ES ESS grading parking lot area in prep for proof roll. 7/21/22 ES ESS grading aggregate on south parking lot. 7/26/22 ES South lot graded and prepared for curb proof roll. 7/29/22 ES Performed proof roll with 20.10 ton load. Passed. 8/1/22 ES ESS backfilling along sidewalks on Lowenstein Dr. 9/16/22 ES Areas along parking lot and sidewalks has all been backfilled on southern edge of Lot 7A. 9/26/22 ES Areas along north side of apartment and in interior courtyard still need grading completed. 11/18/22 ES
Pavement-Curb Construction Passed 11/18/2022
Misc
Informational
09/30/2022
ESS ripping out high back curb in front of buildings 1-3. 9/6/22 ES ESS finished ripping out curb and recompacted subgrade in preparation for curbs. 9/7/22 ES JD Bishop Concrete poured lazy back curbs using KCMMB 4k mix in all areas in front of bldg 1-3. 9/8/22 ES Epic concrete onsite ripping out and replacing curbs for interior courtyard of apartments. 9/28/22 ES Epic concrete onsite pouring new sections of curbs for interior courtyard of apartments. 9/30/22 ES Curb construction completed. 11/18/22 ES
Pavement-Surface Partial 11/18/2022
Misc
Informational
11/08/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
11/08/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
11/08/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES Seal-O-Matic finished laying type 3R asphalt in apartment courtyard as well at north parking lot. Mike from CFS was onsite testing compaction rates. 10/7/22 ES Seal-O-Matic finished laying surface layer of asphalt on southern apartment parking lot. Used Type 3R asphalt. 11/7/22 ES All pavement surfaces have been completed. 11/18/22 ES
Roof Drain Passed 11/18/2022
Misc
Informational
08/03/2022
Steve’s crew with ESS onsite working on roof drains on NE side of of building 1. 7/22/22 ES Steve’s crew working on roof drains on West side of building 2. 7/26/22 ES Steve’s crew working on roof drains on South side of building 2. 7/30/22 ES Steve’s crew working on roof drains on North side of Building 1. 8/1/22 ES Steve’s crew working on roof drains on north side of bldg 1. 8/2/22 ES Steve’s crew working on roof drains on north/east side of bldg 1. 8/3/22 ES Roof drains completed along apartment buildings. 11/18/22 ES
Pavement-Surface Passed 11/18/2022
Misc
Informational
11/18/2022
Seal-O-Matic laid down 1,078 tons 3 inches thick of APWA Type 2 R for the base layer on Black Twig and the parking lot for apartment 1. They will do apartment 2 tomorrow. Mike Simpson was on site doing compaction testing. RP 12-22-21
Misc
Informational
11/18/2022
Seal-O-Matic laid 792 tons 3 inches thick of APWA Type 2 R ashpalt for the first base lift. Mike Simpson from CFS was on site for compaction testing. RP 12-23-21
Misc
Informational
11/18/2022
Performed proof roll with 20.24 ton load on northern parking lot and all of Black Twig Cir. Only area with issue was Far East end near connection to existing parking lot where a sprinkler had saturated the ground. 7/16/22 ES Seal-O-Matic put down 3” of Type 2 R asphalt for first base along northern apartment parking lot and Black Twig Cir. 7/20/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on Black Twig. 7/21/22 ES Seal-O-Matic laying 3” of Type 2 R base asphalt on south parking lot. 8/29/22 ES Seal-O-Matic laying 2” of Type 2 R base asphalt on south parking lot. Total of 499.53 tons today. 8/30/22 ES ESS working on tearing out back sections of base asphalt in apartment’s courtyard area. Will be patching smaller areas with 4K KCMMB concrete and will do larger areas with base asphalt. 9/26/22 ES ESS continues working on tearing out bad sections of pavement and restoring base material. 9/27/22 ES ESS continues working on bad sections of pavement. compacting larger areas with large drum roller. 9/28/22 ES ESS was working on cleaning out interior courtyard of apartments and Black Twig Cir in front of first three townhomes. Seal-O-Matic is to be onsite tomorrow starting next layer of base. 10/4/22 ES Seal-O-Matic was on site laying Type 2R base asphalt in apartment courtyard interior. Mike was CFS was onsite performing compaction testing. 10/5/22 ES Seal-O-Matic began laying type 3R asphalt in apartment courtyard interior. Mike from CFS was onsite performing testing. 10/6/22 ES Seal-O-Matic finished laying type 3R asphalt in apartment courtyard as well at north parking lot. Mike from CFS was onsite testing compaction rates. 10/7/22 ES Seal-O-Matic finished laying surface layer of asphalt on southern apartment parking lot. Used Type 3R asphalt. 11/7/22 ES All pavement surfaces have been completed. 11/18/22 ES
Storm Sewer Construction Inspection Passed 11/18/2022
Misc
Informational
05/25/2022
Chris from ESS set #4 bars every 12 inches while adjusting heights for the 3 field inlets. RP 3-3-22
Misc
Informational
05/25/2022
Rudy’s crew was going to start on roof drains, but had limited access and issues with over poured footings. ESS will work on these at a later time when congestion and materials aren’t in the way. 5/19/22 ES Steve's crew completed roof drains along apartment buildings. 11/18/22 ES
Water Service Inspection Passed 11/18/2022
Misc
Informational
05/23/2022
Tyler, Rudy and crew installed 4 - 2” service meters. 2 for each apartment complex. Then ran those 2 in lines into a 4” C900 line to run into building using all copper line and brass fittings from main to 4” Tee with reducers installed. 5/5/22 ES Rudy’s crew removed 1” irrigation meter and assembly from Lot 7A area, and installed 2 new 1.5” irrigation taps on west side of apartments for apartments and villas. 5/20/22 ES Water services have been installed. 11/18/22 ES
Site Visit Complete 12/06/2022
Misc
Informational
10/14/2022
Met with Codi and Kirk from ESS on site. Discussed project status and was informed they wouldn’t be working the rest of the week due to the weather. RP 2-1-22
Misc
Informational
10/14/2022
No work being done due to the snow storm. RP 2-17-22
Misc
Informational
10/14/2022
No utility or exterior work being done today. RP 2-22-22
Misc
Informational
10/14/2022
No exterior work being done today due to snow. RP 2-24-22
Misc
Informational
10/14/2022
Witnessed the fire lines being flushed. RP 3-4-22
Misc
Informational
10/14/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
10/14/2022
Me and Eric Sharp met with Rudy from ESS to discuss the lowering of the water line across the entrance to the parking lot. RP 4-18-22
Misc
Informational
10/14/2022
Rudy’s crew cut in 45’s and lowered the water line at the parking lot entrance. Poured new kickers supported with rebar reinforcement. RP 4-19-22
Misc
Informational
10/14/2022
Rudy’s crew working on irrigation meters and plugging old tap holes. I took old 1” meter from East side of apartments to return to water. No meter was located on the west side for the villas. 5/20/22 ES No work being done on site today. 5/31/22 ES No utility work being performed, only building construction currently. 6/6/22 ES No work being done today with rain last night. 6/8/22 ES Parking lot/roadway North of apartments from Black Twig to existing apartments was graded out. 6/13/22 ES Northern apartment lot was being graded. 6/15/22 ES Seal-o-matic was onsite performing sub base stabilization on upper part of Black Twig Cir and north parking lot of apartment. 6/16/22 ES Did proof roll on Black Twig Cir and north parking lot of apartments with Cody from ESS, all areas passed. 6/17/22 ES ESS laying and compacting aggregate on Black Twig and north parking lot. 6/20/22 ES
Misc
Informational
10/14/2022
Working on north parking lot and Black Twig Cir. 7/18/22 ES Minor grading work being done. Prepped for asphalt tomorrow. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/4/22 ES No utility work being done. 8/10/22 ES No Utility work being done. 8/11/22 ES No Utility work being done due to rain. 8/16/22 ES Construction continues on apartments, Epic concrete repairing damaged curbing and ESS working on tearing out damaged asphalt base areas. 9/27/22 ES ESS continued sweeping and flushing North parking lot in preps for paving. 10/5/22am ES No utility work requiring inspection being completed. 10/14/22 ES.
Documents & Images
Date Uploaded File Type Document Name
08/31/2021 Receipt Receipt for transaction:2021-007012
09/02/2021 Letter DE-Permit
09/02/2021 Approved SWP Lot 7A GRADING ONLY 9.2.21
09/27/2021 Receipt Receipt for transaction:2021-007591
09/27/2021 Receipt Receipt for transaction:2021-007592
09/30/2021 Approved Plans APPROVED - SWP Lot 7A FDP
09/30/2021 Letter DE-Permit
10/04/2021 FW Addendum - design waiver - pavement
10/04/2021 RE Addendum - design waiver - pavement
11/09/2021 Letter INSPECTION SUMMARY
11/09/2021 Letter INSPECTION SUMMARY
11/15/2021 Letter INSPECTION SUMMARY
11/15/2021 Letter INSPECTION SUMMARY
11/16/2021 Letter INSPECTION SUMMARY
11/17/2021 Letter INSPECTION SUMMARY
11/17/2021 Letter INSPECTION SUMMARY
12/07/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/14/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/15/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
12/18/2021 Letter INSPECTION SUMMARY
12/21/2021 Letter INSPECTION SUMMARY
12/21/2021 Letter INSPECTION SUMMARY
12/22/2021 Letter INSPECTION SUMMARY
12/22/2021 Letter INSPECTION SUMMARY
12/22/2021 Letter INSPECTION SUMMARY
12/23/2021 Letter INSPECTION SUMMARY
01/07/2022 Letter INSPECTION SUMMARY
01/12/2022 Letter INSPECTION SUMMARY
01/12/2022 Letter INSPECTION SUMMARY
01/13/2022 Letter INSPECTION SUMMARY
01/14/2022 Letter INSPECTION SUMMARY
01/14/2022 Letter INSPECTION SUMMARY
01/18/2022 Letter INSPECTION SUMMARY
01/18/2022 Letter INSPECTION SUMMARY
01/18/2022 Letter INSPECTION SUMMARY
02/04/2022 Letter INSPECTION SUMMARY
02/08/2022 Letter INSPECTION SUMMARY
02/09/2022 Letter INSPECTION SUMMARY
02/10/2022 Letter INSPECTION SUMMARY
02/21/2022 Letter INSPECTION SUMMARY
02/22/2022 Letter INSPECTION SUMMARY
02/24/2022 Letter INSPECTION SUMMARY
03/03/2022 Letter INSPECTION SUMMARY
03/04/2022 Letter INSPECTION SUMMARY
03/04/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
03/24/2022 Letter INSPECTION SUMMARY
04/06/2022 Letter INSPECTION SUMMARY
04/18/2022 Letter INSPECTION SUMMARY
04/19/2022 Letter INSPECTION SUMMARY
04/19/2022 Lowered water line
04/29/2022 Approved Plans APPROVED - REVISED SWP Lot 7A 4.29.2022
05/02/2022 Receipt Receipt for transaction: 2022-002733
05/06/2022 Letter INSPECTION SUMMARY
05/12/2022 2 - 2” domestic taps SW building
05/12/2022 2 - 2” meters SW building
05/12/2022 2 - 2” meter pits SW Building
05/12/2022 2 - 2” domestic taps NE building
05/12/2022 2 - 2” domestic lines NE Building
05/12/2022 2 - 2” meters NE building
05/12/2022 Receipt Receipt for transaction:2022-003392
05/23/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/25/2022 Letter INSPECTION SUMMARY
05/31/2022 Letter INSPECTION SUMMARY
06/06/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/16/2022 Letter INSPECTION SUMMARY
06/16/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
07/13/2022 Letter INSPECTION SUMMARY
07/13/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY
07/15/2022 Letter INSPECTION SUMMARY
07/15/2022 Letter INSPECTION SUMMARY
07/16/2022 Letter INSPECTION SUMMARY
07/16/2022 Letter INSPECTION SUMMARY
07/16/2022 Letter INSPECTION SUMMARY
07/16/2022 Letter INSPECTION SUMMARY
07/18/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/10/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/30/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/16/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/30/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY
10/06/2022 Letter INSPECTION SUMMARY
10/06/2022 Letter INSPECTION SUMMARY
10/07/2022 Letter INSPECTION SUMMARY
10/07/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/14/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/21/2022 SWP 2021 4153 Irrigation tap photo 2
11/21/2022 SWP 2021 4153 Irrigation tap photo 1
11/21/2022 SWP 2021 4153 Box B-2 D
11/21/2022 SWP 2021 4153 Box B-2 C
11/21/2022 SWP 2021 4153 Box B-2 B
11/21/2022 SWP 2021 4153 Box B-2 A
12/08/2022 Letter DE-Certificate of Substantial Completion Single Lot
12/12/2022 Lots 7A Streets of West Pryor - Signature at West Pryor Site -Partial Substantial Completion
12/12/2022 Lots 7A Streets of West Pryor - Signature at West Pryor Site -Punch List
01/24/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents
  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:
Browse..

    Portal Home
