Permit Application Status

PRCOM20203513

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20203513
Building Permit - Commercial
Certificate of Occupancy
LEES SUMMIT SCHOOL DIST R 7
ADDITION COMMERCIAL
CONSTRUCTION OF NEW RESTROOMS CONCESSIONS, TICKET BOOTHS AND BLEACHERS
10/05/2020
01/14/2021
04/21/2021
11/05/2021
Locations
Contacts
LEES SUMMIT SCHOOL DIST R 7, Address:600 MILLER
GOULD EVANS, Address:4041 MILL STREET, Phone:(816) 701-5315
Monarch Build, LLC, Address:8100 Newton Street Ste 300, Phone:(913) 942-2400
STACO ELECTRIC CONSTRUCTION COMPANY INC, Address:11030 HICKMAN MILLS DR, Phone:(816) 765-7112
CITY WIDE SHEET METAL, INC, Address:2820 G ROE LN, Phone:(913) 871-7464
PRO DESIGN CONTRACTORS LLC, Address:918 E WARREN ST, Phone:(913) 308-6900
james.mowdy@monarch.build, Address:james.mowdy@monarch.build
Reviews
Review Type Outcome Est. Completion Date Completed
Alarm Plan Review Released for Construction 06/14/2021 06/14/2021
Michael Weissenbach
Installation acceptance testing
Corrective Action Required
06/14/2021

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. (Informational Purposes) Call (816)969-1300 to schedule testing.
Licensed Contractors Approved 11/10/2020 01/14/2021
Mike Weisenborn
LC - MEP Subs
Resolved
01/14/2021

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 11/11/20 - acknowledged in letter
LC - General Contractor
Resolved
01/14/2021

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor. 11/11/20 - acknowledged in letter
Building Plan Review Rejected 11/17/2020 11/11/2020
Joe Frogge
Final Development Plan
Resolved
01/14/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 11/11/20 - acknowledged in letter
IPC 403.1 Minimum number of fixtures
Resolved
11/11/2020

2018 IPC 403.1 Minimum number of fixtures. Plumbing fixtures shall be provided in the minimum number shown in Table 403.1, based on the actual use of the building or space. Uses not shown in Table 403.1 shall be considered individually by the code official. The number of occupants shall be determined by the International Building Code. Action required: Insufficient number of fixtures provided. CMR has been submitted. 11/11/20 - cmr approved
Health Dept Inspection
Corrective Action Required
11/10/2020

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 11/11/20 - acknowledged in letter
Elevator Equipment Permit
Corrective Action Required
11/10/2020

Prior to the installation or construction of any elevator equipment, an elevator equipment permit shall be obtained from the Missouri Department of Public Safety or its authorized representative. Action required: Comment is for informational purposes. 11/11/20 - acknowledged in letter
Elevator Equipment Inspection
Corrective Action Required
11/10/2020

Prior to the operation of any new elevator equipment or the issuance of the operating certificate, such elevator equipment shall be inspected by a licensed inspector. Testing must be performed in accordance with these rules and regulations. The testing must be witnessed by a licensed inspector. Action required: Comment is for informational purposes. 11/11/20 - acknowledged in letter
Elevator Certificate of Inspection
Corrective Action Required
11/10/2020

Elevator Safety Act and Rules 701.361 - Each privately owned or operated installation and each installation owned or operated by the state of Missouri or any political subdivision of the state shall have a certificate of inspection and meet the safety code promulgated pursuant to sections 701.350 to 701.380. Action required: Comment is for informational purposes. 11/11/20 - acknowledged in letter
Miscellaneous Correction
Resolved
11/11/2020

Retaining wall design not found. Action required: Provide complete design or request deferral.
IBC 1209.2 Finish materials
Resolved
11/11/2020

2018 IBC 1209.2 Finish Materials. Walls, Floors and partitions in toilet and bathrooms shall comply with Sections 209.2.1 through 1209.2.4. 2018 1209.2.1 Floors and wall bases. In other than dwelling units, toilet, bathing and shower room floor finish materials shall have a smooth, hard, nonabsorbent surface. The intersections of such floors with walls shall have a smooth, hard, nonabsorbent vertical base that extends upward onto the walls not less than 4 inches. 2018 1209.2.2 Walls and partitions. Walls and partitions within 2 feet of service sinks, urinals and water closets shall have a smooth, hard, nonabsorbent surface, to a height of not less than 4 feet above the floor, and except for structural elements, the materials used in such walls shall be of a type that is not adversely affected by moisture. (See code section for possible exceptions.) 1209.2.3 Showers. (see code for details) 1209.2.4 Waterproof joints. (see code for details) Action required: Specify compliant wall finish materials at water closets and mop sink. If paint is used it must be epoxy based.
Fire Plan Review Approved with Conditions 11/17/2020 11/11/2020
Michael Weissenbach
Miscellaneous Correction
Resolved
11/11/2020

(Action Required) Add exit sign on level 3 (Home press Box)
Key boxes for non-standardized fire service elevator keys
Corrective Action Required
11/10/2020

2018 IFC 506.1.2 Key boxes for non-standardized fire service elevator keys. Key boxes provided for non-standardized fire service elevator keys shall comply with Section 506.1 and 506.2 or as approved by the fire code official. (Action Required) Provide a elevator knox box. Knox box can be obtained from knoxbox.com 11/11/20 (Verified At Inspection)
Health Department Review Approved 11/05/2020
Joe Frogge
Building Plan Review Rejected 10/26/2020 10/23/2020
Joe Frogge
Final Development Plan
Corrective Action Required
10/23/2020

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
IPC 403.1 Minimum number of fixtures
Corrective Action Required
10/23/2020

2018 IPC 403.1 Minimum number of fixtures. Plumbing fixtures shall be provided in the minimum number shown in Table 403.1, based on the actual use of the building or space. Uses not shown in Table 403.1 shall be considered individually by the code official. The number of occupants shall be determined by the International Building Code. Action required: Insufficient number of fixtures provided. CMR has been submitted.
Health Dept Review
Resolved
11/05/2020

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes.
Health Dept Inspection
Corrective Action Required
10/23/2020

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes.
Elevator Equipment Permit
Corrective Action Required
10/23/2020

Prior to the installation or construction of any elevator equipment, an elevator equipment permit shall be obtained from the Missouri Department of Public Safety or its authorized representative. Action required: Comment is for informational purposes.
Elevator Equipment Inspection
Corrective Action Required
10/23/2020

Prior to the operation of any new elevator equipment or the issuance of the operating certificate, such elevator equipment shall be inspected by a licensed inspector. Testing must be performed in accordance with these rules and regulations. The testing must be witnessed by a licensed inspector. Action required: Comment is for informational purposes.
Elevator Certificate of Inspection
Corrective Action Required
10/23/2020

Elevator Safety Act and Rules 701.361 - Each privately owned or operated installation and each installation owned or operated by the state of Missouri or any political subdivision of the state shall have a certificate of inspection and meet the safety code promulgated pursuant to sections 701.350 to 701.380. Action required: Comment is for informational purposes.
Miscellaneous Correction
Corrective Action Required
10/23/2020

Retaining wall design not found. Action required: Provide complete design or request deferral.
IBC 1209.2 Finish materials
Corrective Action Required
10/23/2020

2018 IBC 1209.2 Finish Materials. Walls, Floors and partitions in toilet and bathrooms shall comply with Sections 209.2.1 through 1209.2.4. 2018 1209.2.1 Floors and wall bases. In other than dwelling units, toilet, bathing and shower room floor finish materials shall have a smooth, hard, nonabsorbent surface. The intersections of such floors with walls shall have a smooth, hard, nonabsorbent vertical base that extends upward onto the walls not less than 4 inches. 2018 1209.2.2 Walls and partitions. Walls and partitions within 2 feet of service sinks, urinals and water closets shall have a smooth, hard, nonabsorbent surface, to a height of not less than 4 feet above the floor, and except for structural elements, the materials used in such walls shall be of a type that is not adversely affected by moisture. (See code section for possible exceptions.) 1209.2.3 Showers. (see code for details) 1209.2.4 Waterproof joints. (see code for details) Action required: Specify compliant wall finish materials at water closets and mop sink. If paint is used it must be epoxy based.
Licensed Contractors Rejected 10/26/2020 10/23/2020
Joe Frogge
LC - MEP Subs
Corrective Action Required
10/23/2020

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
LC - General Contractor
Corrective Action Required
10/23/2020

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor.
Fire Plan Review Approved with Conditions 10/26/2020 10/19/2020
Michael Weissenbach
Miscellaneous Correction
Corrective Action Required
10/19/2020

(Action Required) Add exit sign on level 3 (Home press Box)
Key boxes for non-standardized fire service elevator keys
Corrective Action Required
10/19/2020

2018 IFC 506.1.2 Key boxes for non-standardized fire service elevator keys. Key boxes provided for non-standardized fire service elevator keys shall comply with Section 506.1 and 506.2 or as approved by the fire code official. (Action Required) Provide a elevator knox box. Knox box can be obtained from knoxbox.com
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for Addition to Commercial $17,758.40 $17,758.40 Paid 01/14/2021
9110068-Storm Fee $945.75 $945.75 Paid 01/14/2021
9110081-Paved Surface Inspection Fee $6,398.29 $6,398.29 Paid 01/14/2021
91100C9-Water Insp Fee $135.00 $135.00 Paid 01/14/2021
91100C8-Sanitary Sewer Insp Fees $163.20 $163.20 Paid 01/14/2021
9110071-Site Grading Fee $720.00 $720.00 Paid 01/14/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Underground Electrical Inspection - Commercial Partial 1/20/2021 1/20/2021 01/20/2021
Misc
Informational
01/20/2021
- UNDERGROUND CONDUIT FOR PRIMARY SOUTH END OF TENNIS COURTS -
Underground Electrical Inspection - Commercial Partial 1/22/2021 1/22/2021 01/22/2021
Misc
Informational
01/20/2021
- UNDERGROUND CONDUIT FOR PRIMARY SOUTH END OF TENNIS COURTS - - 6" & 8" CONDUIT 34' TO SOUTH @ SE END OF TENNIS COURT -
Site Visit Partial 1/25/2021 1/25/2021 01/25/2021
Misc
Informational
01/25/2021
1-25-21 10:40am Light rain. They are moving equipment on site.
Site Visit Partial 1/26/2021 1/26/2021 01/26/2021
Misc
Informational
01/25/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place.
Underground Electrical Inspection - Commercial Partial 1/29/2021 1/29/2021 01/29/2021
Misc
Informational
01/22/2021
- UNDERGROUND CONDUIT FOR PRIMARY SOUTH END OF TENNIS COURTS - - 6" & 8" CONDUIT 34' TO SOUTH @ SE END OF TENNIS COURT - - 100' TO SOUTH @ SE END OF TENNIS COURT -
Storm Sewer Construction Inspection Partial 1/29/2021 1/29/2021 01/29/2021
Misc
Informational
01/29/2021
1-29-21 9:46am Pro Design Contractors is on site installing the storm pipe.
Misc
Informational
01/29/2021
1-29-21 9:46am Pro Design Contractors is on site installing the storm pipe. 11:24am They have installed pipe from K6 to K5. They have one stick coming out of K5. They have been informed to use 6” of rock on bottom and sides with 12” of rock over the top per spec. They cannot get compaction to backfill today due to wet soil.
Site Visit Partial 02/03/2021
Misc
Informational
01/26/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site.
Site Visit Partial 02/03/2021
Misc
Informational
02/03/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box.
Storm Sewer Construction Inspection Partial 02/04/2021
Misc
Informational
02/04/2021

2-4-21 11:43am They have approximately 120’ of storm placed today. They will be backfilling. They are waiting for more material to arrive.
Storm Sewer Construction Inspection Partial 2/5/2021 2/5/2021 02/05/2021
Misc
Informational
01/29/2021
1-29-21 9:46am Pro Design Contractors is on site installing the storm pipe.
Misc
Informational
01/29/2021
1-29-21 9:46am Pro Design Contractors is on site installing the storm pipe. 11:24am They have installed pipe from K6 to K5. They have one stick coming out of K5. They have been informed to use 6” of rock on bottom and sides with 12” of rock over the top per spec. They cannot get compaction to backfill today due to wet soil. 2-2-21 3:18pm They have installed storm pipe north to K1. They are backfilling and getting compaction testing. 2-5-21 9:31am Pro Designs are digging out to set a storm box. 10:17am They have tied into K7 box. They have poured the collar. The storm line is complete and they are backfilling.
Water Line - Construction Inspection Partial 2/5/2021 2/5/2021 02/05/2021
Misc
Informational
02/05/2021

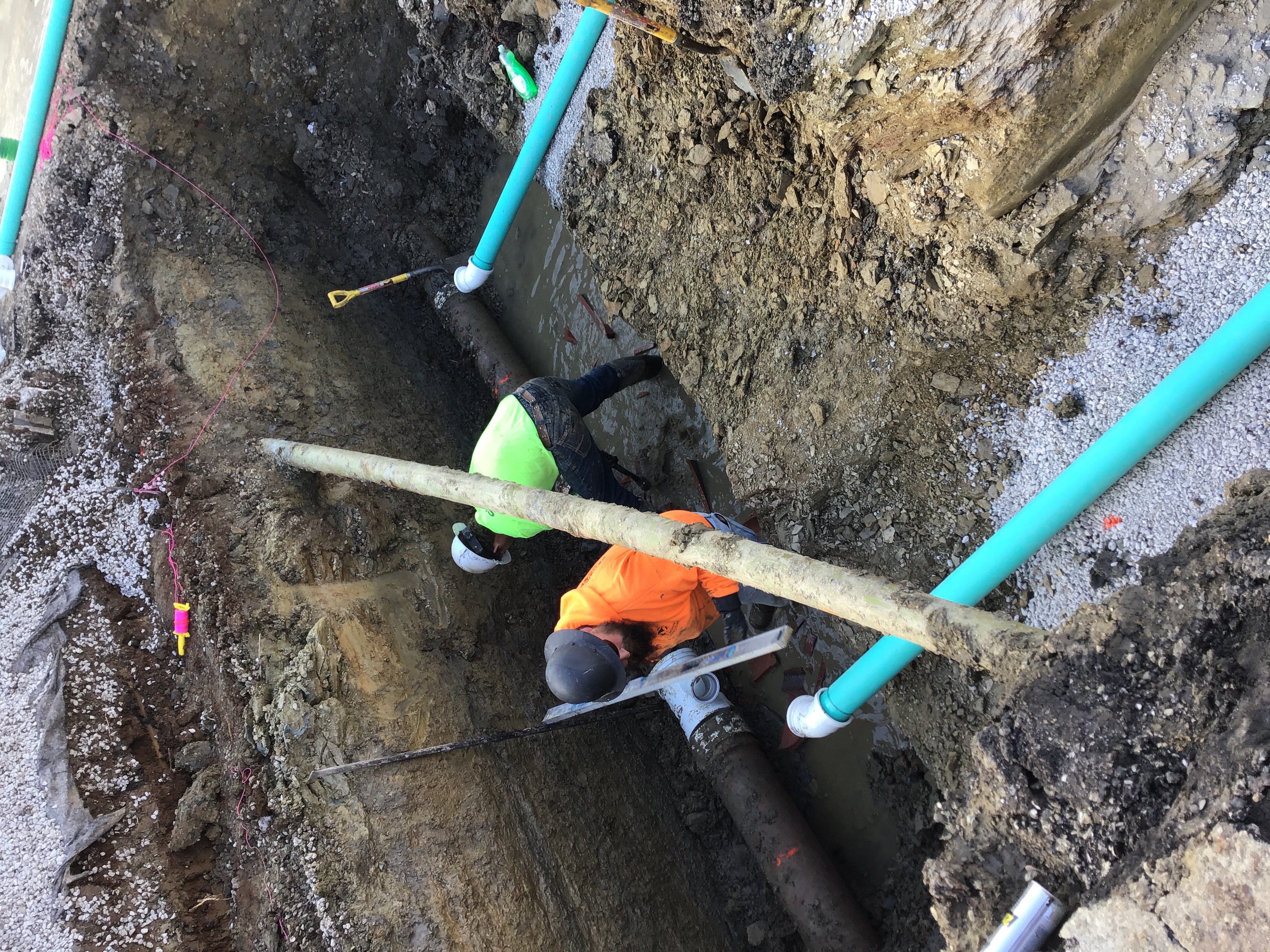

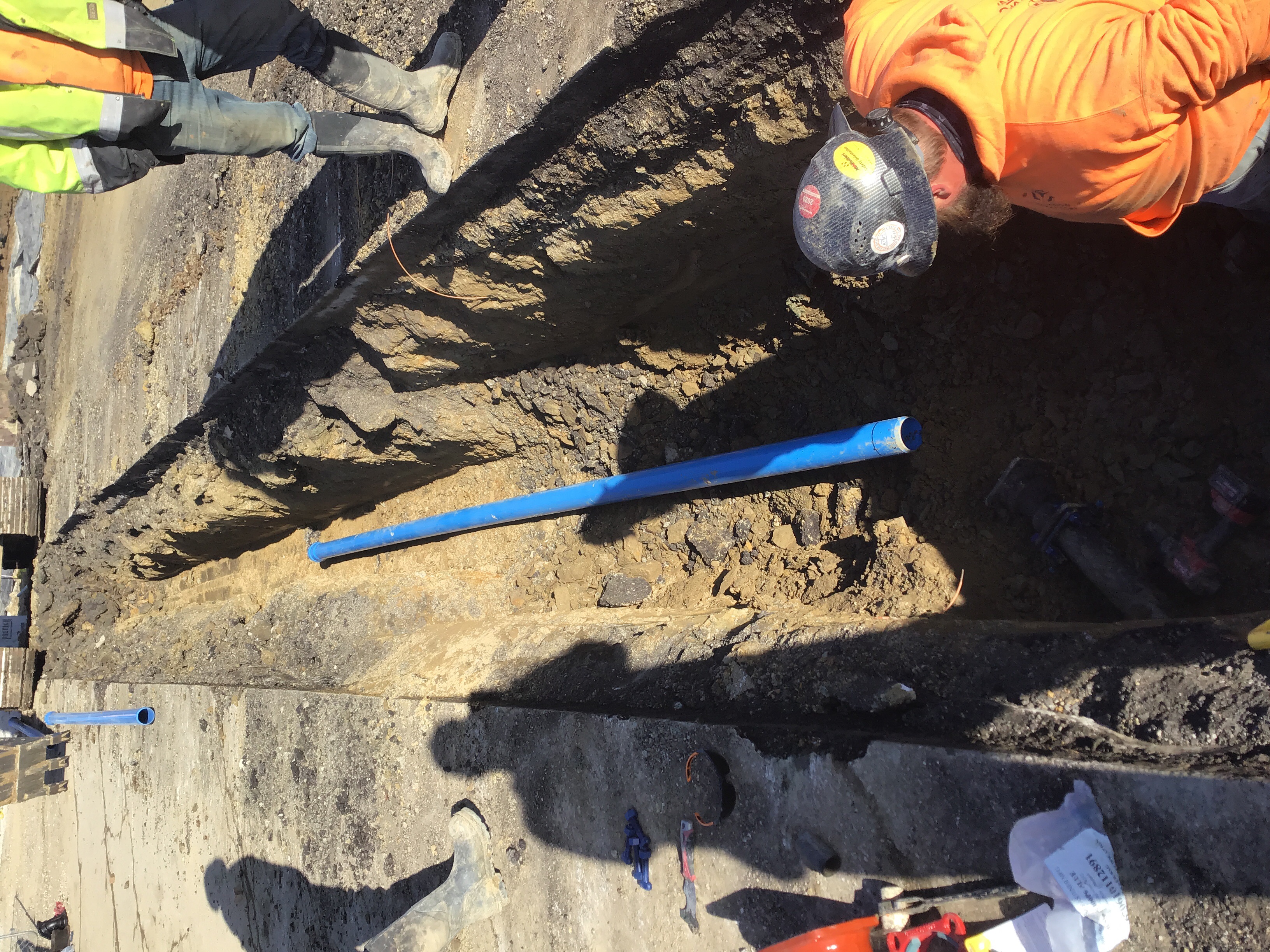

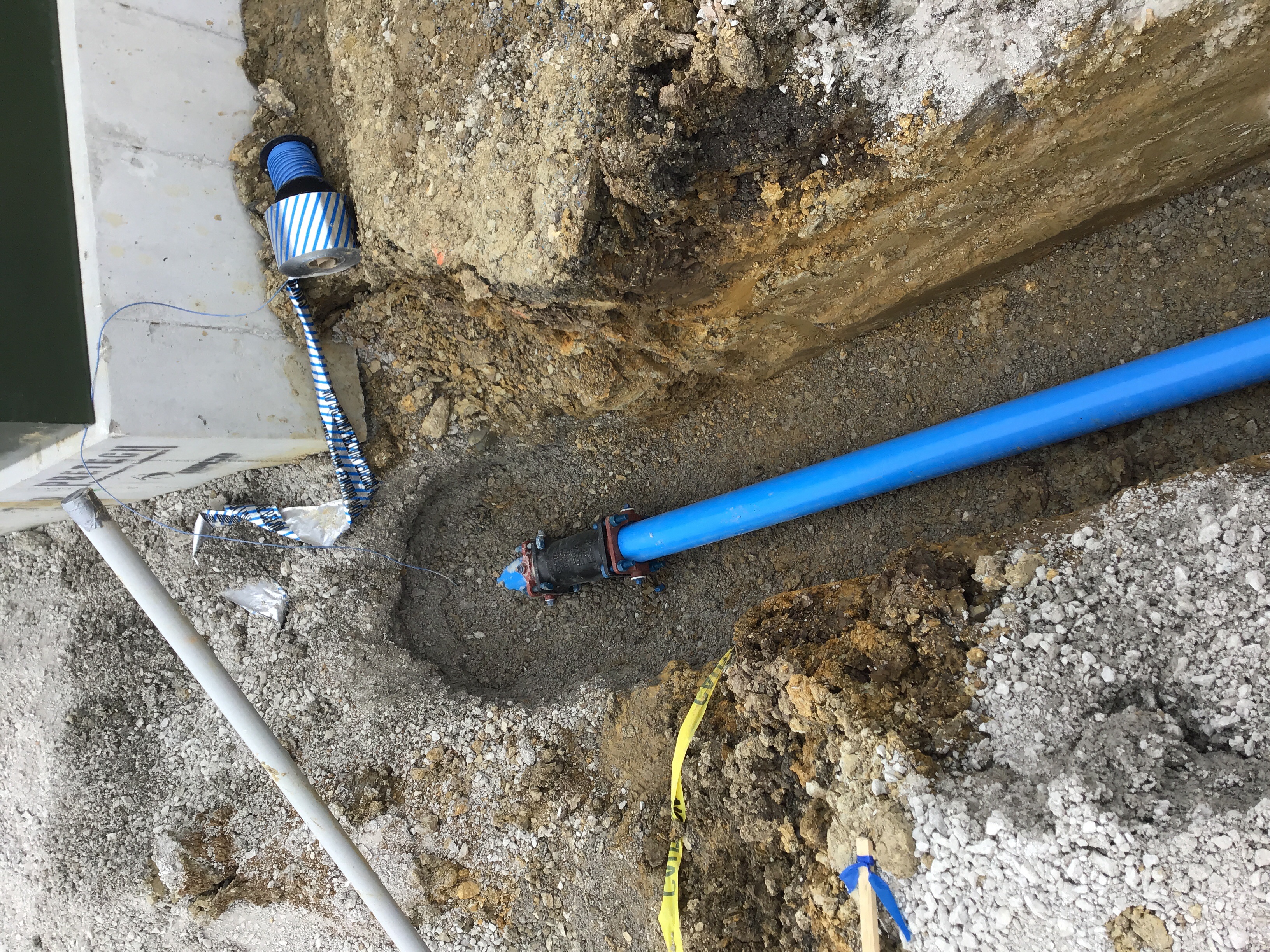

2-5-21 3:30pm They are laying approximately 70’ of water line. They will be sending me pics.
Site Visit Partial 02/08/2021
Misc
Informational
02/03/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather.
Site Visit Partial 02/09/2021
Misc
Informational
02/08/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place.
Site Visit Partial 2/10/2021 2/10/2021 02/10/2021
Misc
Informational
02/09/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site.
Site Visit Partial 2/22/2021 2/22/2021 02/22/2021
Misc
Informational
02/10/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade.
Storm Sewer Construction Inspection Partial 02/22/2021
Misc
Informational
02/05/2021

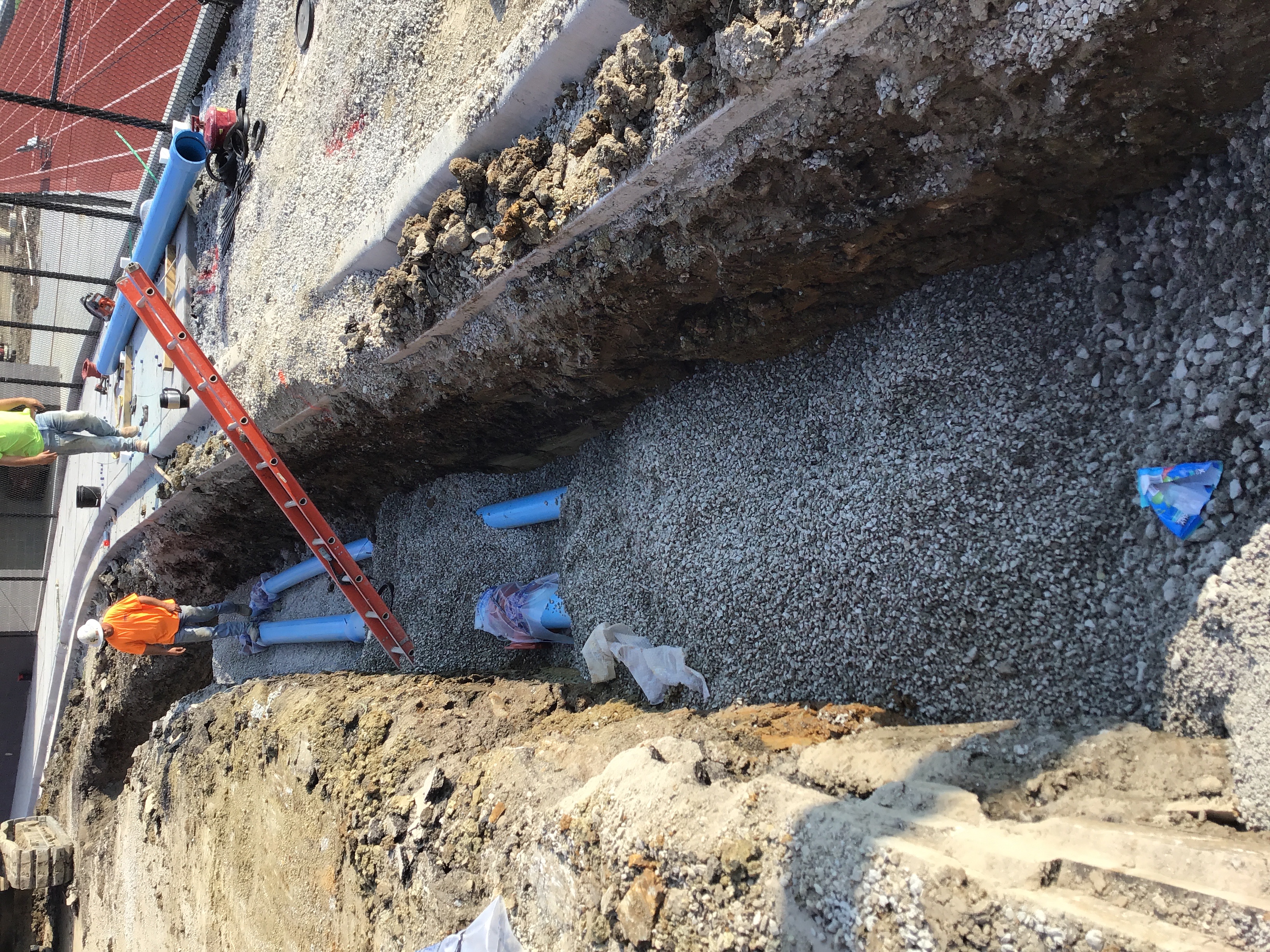

2-4-21 11:43am They have approximately 120’ of storm placed today. They will be backfilling. They are waiting for more material to arrive. 2-22-21 2:32pm They have dug up and moved approximately 190’ of storm pipe due to a revision. They are using plenty of rock and have a third party inspector on site for compaction.
Water Line - Construction Inspection Partial 02/22/2021
Misc
Informational
02/05/2021
2-5-21 3:30pm They are laying approximately 70’ of water line. They will be sending me pics. 2-22-21 2:37pm They installed approximately 100’ of water line with kickers. I have all pics of fittings and pipe and kickers.
Sanitary Sewer Construction Inspection Partial 2/23/2021 2/23/2021 02/23/2021
Misc
Informational
02/23/2021

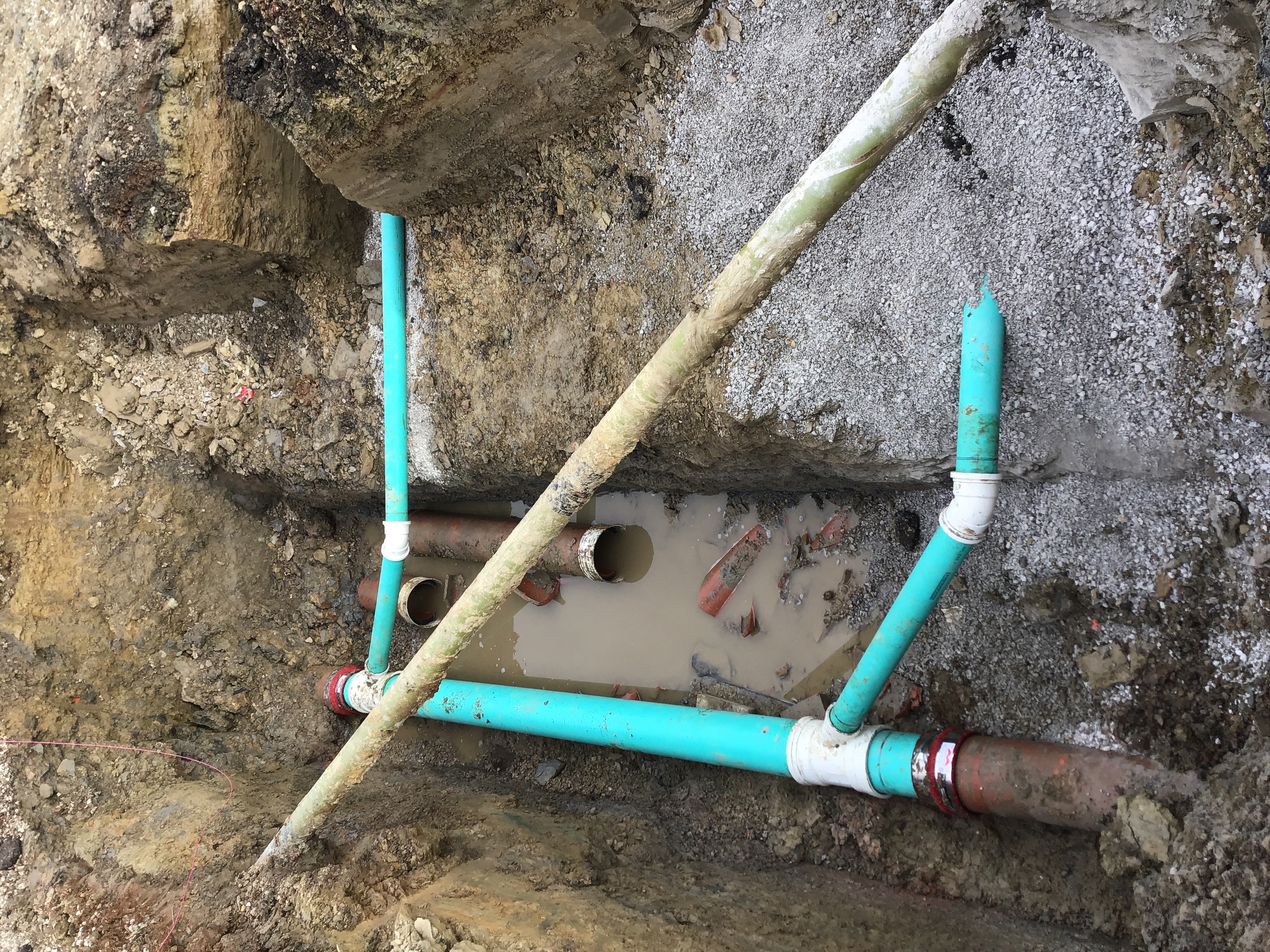

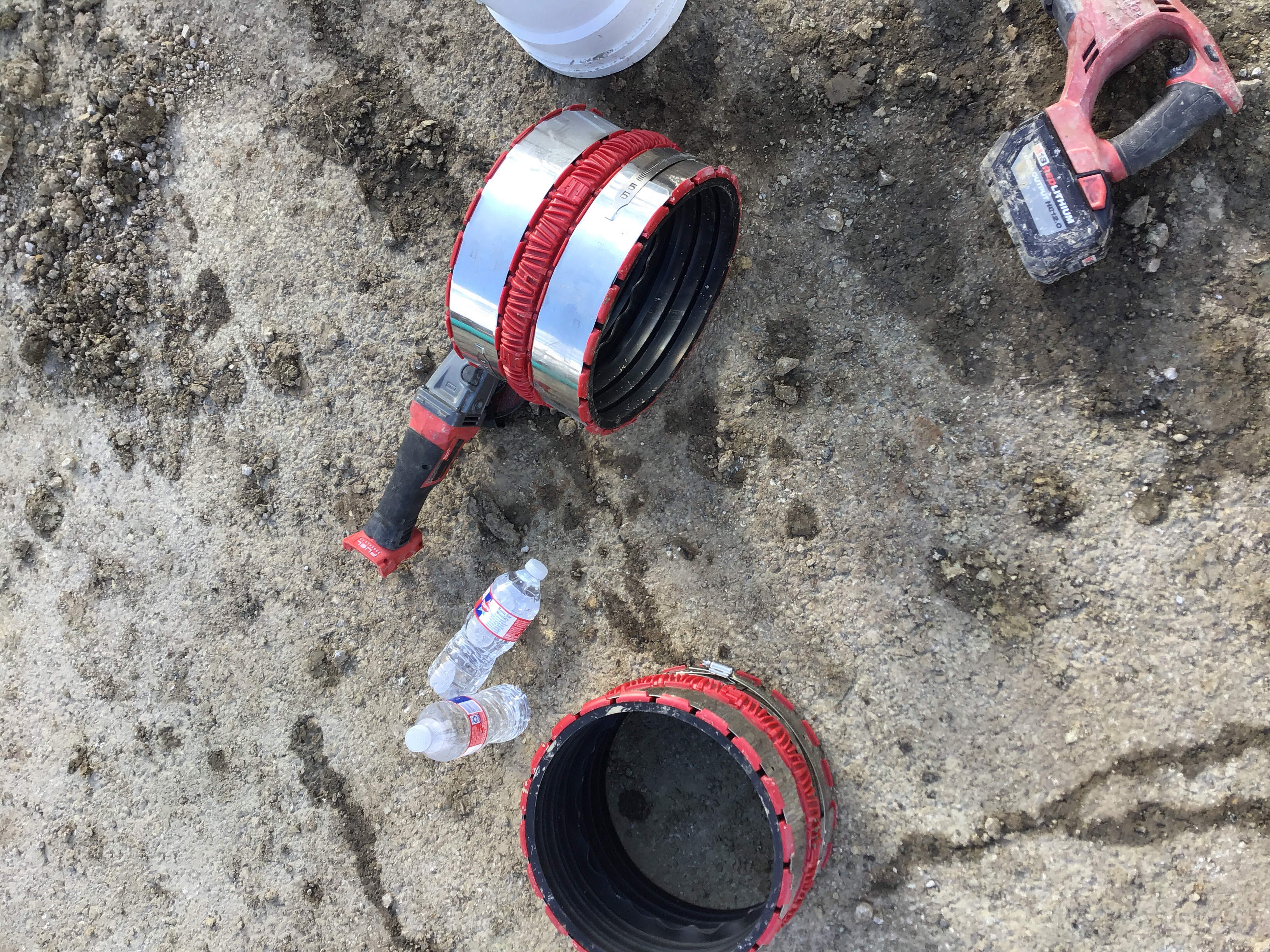

2-23-21 3:21pm They have dug up the sanitary service line and it runs under a retaining wall. They will not be able to do any work till the wall is removed.
Sanitary Sewer Construction Inspection Partial 2/24/2021 2/24/2021 02/24/2021
Misc
Informational
02/23/2021
2-23-21 3:21pm They have dug up the sanitary service line and it runs under a retaining wall. They will not be able to do any work till the wall is removed. 2-24-21 1:31pm They are digging up for the service lines and are working around a gas line. They should be ready for a inspection at 3pm. 3:27pm They have just cut in the main to install the wyes. They will leave it open for a inspection in the morning.
Water Line - Construction Inspection Partial 02/25/2021
Misc
Informational
02/22/2021
2-5-21 3:30pm They are laying approximately 70’ of water line. They will be sending me pics. 2-22-21 2:37pm They installed approximately 100’ of water line with kickers. I have all pics of fittings and pipe and kickers. 2-25-21 2:15pm They have ran the water line up to the pad site.
Site Visit Partial 3/1/2021 3/1/2021 03/01/2021
Misc
Informational
02/22/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm.
Footing Inspection - Commercial Partial 3/2/2021 (1:30) 3/2/2021 03/02/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/02/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 -
Storm Sewer Construction Inspection Partial 3/2/2021 3/2/2021 03/02/2021
Misc
Informational
02/22/2021
2-4-21 11:43am They have approximately 120’ of storm placed today. They will be backfilling. They are waiting for more material to arrive. 2-22-21 2:32pm They have dug up and moved approximately 190’ of storm pipe due to a revision. They are using plenty of rock and have a third party inspector on site for compaction. 3-2-21 10:10am CFS is on site for testing. Pro Design are installing storm pipe.
Footing Inspection - Commercial Partial 3/3/2021 03/03/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/02/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM -
Site Visit Partial 03/03/2021
Misc
Informational
03/01/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time.
Site Visit Partial 3/4/2021 03/04/2021
Misc
Informational
03/03/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time.
Footing Inspection - Commercial Partial 3/4/2021 (2:00) 3/4/2021 03/04/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/03/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING -
Footing Inspection - Commercial Partial 3/5/2021 03/05/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/04/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD -
Site Visit Partial 3/5/2021 03/05/2021
Misc
Informational
03/04/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time.
Footing Inspection - Commercial Partial 3/5/2021 (1:30) 3/5/2021 03/05/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/05/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT-
Footing Inspection - Commercial Partial 3/8/2021 03/08/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/05/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT-
Site Visit Partial 3/9/2021 3/9/2021 03/09/2021
Misc
Informational
03/05/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time.
Underslab Plumbing Inspection - Commercial Partial 3/10/2021 03/10/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/10/2021
- RESTROOM BLDG -
Underslab Electrical Inspection - Commercial Partial 3/10/2021 03/10/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/10/2021
- UNDERSLAB CONDUIT PRESS BOX NEAR ELEVATOR PIT -
Site Visit Partial 3/11/2021 03/11/2021
Misc
Informational
03/09/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time.
Underslab Plumbing Inspection - Commercial Partial 3/12/2021 3/11/2021 03/11/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/10/2021
- RESTROOM BLDG - - CONCESSION STAND -
Site Visit Partial 3/12/2021 3/12/2021 03/12/2021
Misc
Informational
03/11/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place.
Site Visit Partial 3/15/2021 3/15/2021 03/15/2021
Misc
Informational
03/12/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place. 3-15-21 9:48am The work taking place requires no inspections from me.
Erosion Control Inspection Partial 3/16/2021 3/16/2021 03/16/2021
Misc
Informational
03/16/2021
3-16-21 11:15am Erosion controls are in place and working.
Erosion Control Inspection Partial 3/18/2021 3/18/2021 03/18/2021
Misc
Informational
03/16/2021
3-16-21 11:15am Erosion controls are in place and working. 3-18-21 3:08pm Erosion controls are in place and working.
Water Line - Hydrostatic Test Passed 3/19/2021 3/19/2021 03/19/2021
Misc
Informational
03/19/2021
3-19-21 9:30am Pro Design Contractors have started the test. It is at 150psi and we will hold it for two hours. The gauge being used does not have a certification sticker on it. They said it is new out of the box a will get me the receipt. Steve Robbins is off today and has informed me in the past that this can be excepted. The gauge keeps losing pressure. 12pm we started the test again. It is at 151 at 12pm. 1pm The pressure is holding at 151. 2pm The psi held at 151. The has passed.
Water Line - Construction Inspection Passed 03/19/2021
Misc
Informational
02/25/2021
2-5-21 3:30pm They are laying approximately 70’ of water line. They will be sending me pics. 2-22-21 2:37pm They installed approximately 100’ of water line with kickers. I have all pics of fittings and pipe and kickers. 2-25-21 2:15pm They have ran the water line up to the pad site. 3-19-21 3:22pm We are chlorinating approximately 90’ of water line. 3:31pm The line is chlorinated.
Water Line - Construction Inspection Passed 03/22/2021
Misc
Informational
03/22/2021
3-22-21 8:16am Pro Design flushed the chlorine out of the water line. The line is clean and we will pull the first sample on 3-23-21 weather permitting.
Underslab Electrical Inspection - Commercial Partial 3/22/2021 3/22/2021 03/22/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/10/2021
- UNDERSLAB CONDUIT PRESS BOX NEAR ELEVATOR PIT - - UNDERSLAB CONDUIT RESTROOMS & CONCESSION STAND -
Underslab Plumbing Inspection - Commercial Partial 3/22/2021 3/22/2021 03/22/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/11/2021
- RESTROOM BLDG - - CONCESSION STAND - - OK TO POUR SLAB WHEN READY -
Water Line - Coliform Test 2 Partial 3/24/2021 3/24/2021 03/24/2021
Misc
Informational
03/24/2021
3-24-21 9:25am 46 degrees with a overcast and damp out. Pro Design pulled the second water sample. I will take it to the lab for testing. 10:14am I dropped off the sample at lab.
Water Line - Coliform Test 1 Passed 3/23/2021 3/23/2021 03/26/2021
Misc
Informational
03/23/2021
3-23-21 Pro Design Construction is on site and we will be pulling the first water sample. We pulled the sample at 9:37am in a light wind. The sample is on ice and I will be taking it to the lab. 11:30am I have dropped the water sample off at the lab.
Misc
Corrective Action Required
03/25/2021
3-25-21 8:21AM Keystone Lab has sent A email saying sample 1 has passed. I attached the results to Documents and Images.
Water Line - Coliform Test 2 Passed 3/26/2021 03/26/2021
Misc
Informational
03/24/2021
3-24-21 9:25am 46 degrees with a overcast and damp out. Pro Design pulled the second water sample. I will take it to the lab for testing. 10:14am I dropped off the sample at lab.
Misc
Corrective Action Required
03/26/2021
3-26-21 7:05am The second water sample has passed and the document has been attached to Documents and Images.
Water Line - Coliform Test 2 Passed 03/26/2021
Site Visit Partial 3/26/2021 3/26/2021 03/26/2021
Misc
Informational
03/15/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place. 3-15-21 9:48am The work taking place requires no inspections from me. 3-26-21 8:56am Pro design is on site to backfill the water line.
Site Visit Partial 03/29/2021
Misc
Informational
03/26/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place. 3-15-21 9:48am The work taking place requires no inspections from me. 3-26-21 8:56am Pro design is on site to backfill the water line. 3-29-21 10:29am The work taking place does not require inspections at this time. Pro Design has backfilled the water line.
Footing Inspection - Commercial Partial 3/30/2021 03/30/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/08/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH, UFER SW FOOTING -
Site Visit Partial 3/31/2021 03/31/2021
Misc
Informational
03/29/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place. 3-15-21 9:48am The work taking place requires no inspections from me. 3-26-21 8:56am Pro design is on site to backfill the water line. 3-29-21 10:29am The work taking place does not require inspections at this time. Pro Design has backfilled the water line. 3-31-21 9:58am No inspections are needed at this time.
Footing Inspection - Commercial Partial 4/5/2021 (1:30) 4/5/2021 04/05/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/30/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD 25' EAST TO WEST -
Footing Inspection - Commercial Partial 4/6/2021 (2:00) 4/6/2021 04/06/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/05/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD 25' EAST TO WEST - - RETAINING WALL SOUTH END 5' EAST TO WEST -
Underslab Electrical Inspection - Commercial Partial 4/7/2021 4/7/2021 04/07/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/22/2021
- UNDERSLAB CONDUIT PRESS BOX NEAR ELEVATOR PIT - - UNDERSLAB CONDUIT RESTROOMS & CONCESSION STAND - - UNDERSLAB CONDUIT VISITOR SIDE TICKET BOOTH -
Footing Inspection - Commercial Partial 4/14/2021 (2:00) 4/14/2021 04/14/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/06/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD 25' EAST TO WEST - - RETAINING WALL SOUTH END 5' EAST TO WEST - - RETAINING WALL SOUTH END FOOTBALL FIELD 30' TO WEST -
In-wall Inspection Partial 4/15/2021 4/15/2021 04/15/2021
Miscellaneous Correction
Informational
04/15/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE
Footing Inspection - Commercial Partial 4/15/2021 4/15/2021 04/15/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/14/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND
Footing Inspection - Commercial Partial 4/21/2021 (11:30) 4/21/2021 04/21/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/15/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE -
Foundation Inspection - Commercial Partial 4/26/2021 04/26/2021
Misc
Informational
04/26/2021
-Retaining wall south of football field complete
Storm Sewer Construction Inspection Partial 5/13/2021 5/13/2021 05/13/2021
Misc
Informational
03/02/2021
2-4-21 11:43am They have approximately 120’ of storm placed today. They will be backfilling. They are waiting for more material to arrive. 2-22-21 2:32pm They have dug up and moved approximately 190’ of storm pipe due to a revision. They are using plenty of rock and have a third party inspector on site for compaction. 3-2-21 10:10am CFS is on site for testing. Pro Design are installing storm pipe. 5-13-21 9:39am Blue Nile has installed roof drains on the back side of the concession stand. They have rock and the correct fittings. On 5-12-21 they installed drains for the tower per plan. I did not see the tower drains installed.
Underground Electrical Inspection - Commercial Partial 5/20/2021 5/20/2021 05/20/2021
Misc
Informational
01/29/2021
- UNDERGROUND CONDUIT FOR PRIMARY SOUTH END OF TENNIS COURTS - - 6" & 8" CONDUIT 34' TO SOUTH @ SE END OF TENNIS COURT - - 100' TO SOUTH @ SE END OF TENNIS COURT - - (2) DRIVEN GROUND RODS OUTSIDE ELECTRICAL ROOM DOOR RESTROOMS BLDG -
In-wall Inspection Partial 5/26/2021 05/26/2021
Miscellaneous Correction
Informational
04/15/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE CHECK CLEARANCE SUSPENDED TRANSFORMER ABOVE SERVICE PANEL AT FUTURE WATER HEATER
In-wall Inspection Partial 5/27/2021 5/27/2021 05/27/2021
Miscellaneous Correction
Informational
05/26/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE CHECK CLEARANCE SUSPENDED TRANSFORMER ABOVE SERVICE PANEL AT FUTURE WATER HEATER - 2ND FLOOR PRESS BOXES -
In-wall Inspection Partial 6/4/2021 06/04/2021
Miscellaneous Correction
Informational
05/27/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE CHECK CLEARANCE SUSPENDED TRANSFORMER ABOVE SERVICE PANEL AT FUTURE WATER HEATER - 2ND FLOOR PRESS BOXES - - CONCESSION STAND -
Above Ceiling Inspection Partial 6/4/2021 6/4/2021 06/04/2021
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
06/04/2021
- RESTROOMS, CONCESSION STAND - - PROVIDE LIGHT FIXTURES, COVER OPEN J BOXES TICKET BOOTH END OF CONCESSION BLDG -
Footing Inspection - Commercial Partial 6/9/2021 (9:00) 6/9/2021 06/09/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/21/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40
Footing Inspection - Commercial Partial 6/14/2021 6/14/2021 06/14/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
06/09/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40 - - C LINE 24-40 (6) PIERS, A LINE PIERS 2-18, NORTH RAMP (3) PIERS, NORTH STAIR LANDING & PIER -
Site Visit Partial 6/16/2021 6/16/2021 06/16/2021
Misc
Informational
03/31/2021
1-25-21 10:40am Light rain. They are moving equipment on site. 1-26-21 11:02am Staco Electric is on site doing work. There is no other work taking place. 2-3-21 1:34pm They are digging out for storm pip at the north end of the site. 3:50pm They have installed 2 sticks of storm pipe and cut into the existing storm box. 2-4-21 8:51am Pro Design is on site installing storm pipe. Bad weather is expected later today. 2-8-21 8:46am There is no work taking place due to weather. 2-9-21 8:19am Snow. No work taking place. 2-10-21 9:12am Light snow. No work taking place on site. 2-22-21 8:26am There is a crew on site cutting grade. 3-1-21 8:06am They are digging on the east side of the site for storm. 3-3-21 1:18pm The work on site require no inspections from me at this time. 3-4-21 10am The work taking place does not require inspections from me at this time. 3-5-21 11:20am There is no work taking place that needs inspections at this time. 3-9-021 3pm No inspections are needed at this time. 3-11-21 11:17am The work taking place does not require any inspections from me at this time. 3-12-21 11:32am Rain. There is no work taking place. 3-15-21 9:48am The work taking place requires no inspections from me. 3-26-21 8:56am Pro design is on site to backfill the water line. 3-29-21 10:29am The work taking place does not require inspections at this time. Pro Design has backfilled the water line. 3-31-21 9:58am No inspections are needed at this time. 6-16-21 8:20am There are no inspections needed at this time.
Rated Assembly Inspection Partial 6/16/2021 06/16/2021
Misc
Informational
06/16/2021
: THE FOLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT 1" GYPSUM BOARD INNER SHAFT ALL FLOORS
Rough Framing Inspection - Commercial Partial 6/16/2021 6/16/2021 06/16/2021
Misc
Informational
06/16/2021
: THE FOLLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT METAL STUD FRAMING ALL FLOORS
Footing Inspection - Commercial Partial 6/16/2021 (3:30) 6/16/2021 06/16/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
06/14/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40 - - C LINE 24-40 (6) PIERS, A LINE PIERS 2-18, NORTH RAMP (3) PIERS, NORTH STAIR LANDING & PIER - - B LINE (6) COLUMN PADS & PIERS -
Footing Inspection - Commercial Partial 6/21/2021 6/21/2021 06/21/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
06/16/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40 - - C LINE 24-40 (6) PIERS, A LINE PIERS 2-18, NORTH RAMP (3) PIERS, NORTH STAIR LANDING & PIER - - B LINE (6) COLUMN PADS & PIERS - - C LINE PIERS AND COLUMN PADS COMPLETE, SOUTH RAMP, SOUTH STAIR LANDING & PIER -
Rough Framing Inspection - Commercial Partial 6/21/2021 6/21/2021 06/21/2021
Misc
Informational
06/16/2021
: THE FOLLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT METAL STUD FRAMING ALL FLOORS METAL STUD FRAMING AT ELEVATOR DOORS ALL FLOORS
Rated Assembly Inspection Partial 6/24/2021 6/24/2021 06/24/2021
Misc
Informational
06/16/2021
: THE FOLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT 1" GYPSUM BOARD INNER SHAFT ALL FLOORS - 1ST LAYER 5/8 TYPE X OUTSIDE ELEVATOR SHAFT ALL FLOORS -
Footing Inspection - Commercial Partial 6/24/2021 6/24/2021 06/24/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
06/21/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40 - - C LINE 24-40 (6) PIERS, A LINE PIERS 2-18, NORTH RAMP (3) PIERS, NORTH STAIR LANDING & PIER - - B LINE (6) COLUMN PADS & PIERS - - C LINE PIERS AND COLUMN PADS COMPLETE, SOUTH RAMP, SOUTH STAIR LANDING & PIER - - (2) COLUMN PADS & PIERS LINE A & B SOUTH RAMP & STAIR LANDING -
In-wall Inspection Partial 7/19/2021 7/19/2021 07/19/2021
Miscellaneous Correction
Informational
06/04/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE CHECK CLEARANCE SUSPENDED TRANSFORMER ABOVE SERVICE PANEL AT FUTURE WATER HEATER - 2ND FLOOR PRESS BOXES - - CONCESSION STAND - - PRE FINAL CONCESSION STAND, WOMENS RESTROOM, MENS RESTROOM, GFCIs. NEED TO COMPLETE FLUSH VALVES URNIALS
In-wall Inspection Passed 8/23/2021 08/23/2021
Miscellaneous Correction
Informational
07/19/2021
AREAS APPROVED: IN WALL FOR BATHROOMS COMPLETE CHECK CLEARANCE SUSPENDED TRANSFORMER ABOVE SERVICE PANEL AT FUTURE WATER HEATER - 2ND FLOOR PRESS BOXES - - CONCESSION STAND - - PRE FINAL CONCESSION STAND, WOMENS RESTROOM, MENS RESTROOM, GFCIs.
Above Ceiling Inspection Passed 08/23/2021
THE FOLLOWING AREAS ARE APPROVED
Resolved
08/23/2021
Footing Inspection - Commercial Passed 8/23/2021 08/23/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
06/24/2021
: PRESS BOX : - NORTH END DETAIL 10 S200 ELEVATOR PIT - - RESTROOMS LINE K TO P / LINE 7 TO 9 UFER EAST FOOTING AT MECHANICAL ROOM - - RESTROOMS FOOTING COMPLETE OK TO POUR- - CONCESSION STAND SE END NOT DUG OK TO POUR 3 SIDES, UFER IN SW FOOTING - - FOOTINGS SOUTH OF ELEVATOR PIT BULKHEAD @ COLUMN PAD - - HOME PRESS BOX COLUMN PADS & FOOTINGS - - COLUMN PAD, SPREAD FOOTING SOUTH OF ELEVATOR PIT- - VISTITORS SIDE TICKET BOOTH - - RETAINING WALL SOUTH END OF FIELD TO CORNER AND 14' NORTH TOWARDS CONCESSION STAND- - RETAINING WALL SOUTH END COMPLETE - -COLUMN PADS AND PIERS FOR WEST BLEACHERS AT LINES: A21-A40 - - C LINE 24-40 (6) PIERS, A LINE PIERS 2-18, NORTH RAMP (3) PIERS, NORTH STAIR LANDING & PIER - - B LINE (6) COLUMN PADS & PIERS - - C LINE PIERS AND COLUMN PADS COMPLETE, SOUTH RAMP, SOUTH STAIR LANDING & PIER - - (2) COLUMN PADS & PIERS LINE A & B SOUTH RAMP & STAIR LANDING -
Foundation Inspection - Commercial Passed 8/23/2021 08/23/2021
Misc
Informational
04/26/2021
-Retaining wall south of football field complete
Piers/Caissons Inspection - Commercial Passed 08/23/2021
Misc
Informational
08/23/2021
CALLED IN AS FOOTING INSPECTIONS
Rated Assembly Inspection Passed 8/23/2021 08/23/2021
Misc
Informational
06/24/2021
: THE FOLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT 1" GYPSUM BOARD INNER SHAFT ALL FLOORS - 1ST LAYER 5/8 TYPE X OUTSIDE ELEVATOR SHAFT ALL FLOORS -
Rough Framing Inspection - Commercial Passed 8/23/2021 08/23/2021
Misc
Informational
06/21/2021
: THE FOLLOWING AREAS ARE APPROVED : PRESS BOX ELEVATOR SHAFT METAL STUD FRAMING ALL FLOORS METAL STUD FRAMING AT ELEVATOR DOORS ALL FLOORS
Underground Electrical Inspection - Commercial Passed 8/23/2021 08/23/2021
Misc
Informational
05/20/2021
- UNDERGROUND CONDUIT FOR PRIMARY SOUTH END OF TENNIS COURTS - - 6" & 8" CONDUIT 34' TO SOUTH @ SE END OF TENNIS COURT - - 100' TO SOUTH @ SE END OF TENNIS COURT - - (2) DRIVEN GROUND RODS OUTSIDE ELECTRICAL ROOM DOOR RESTROOMS BLDG -
Underslab Electrical Inspection - Commercial Passed 8/23/2021 08/23/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
04/07/2021
- UNDERSLAB CONDUIT PRESS BOX NEAR ELEVATOR PIT - - UNDERSLAB CONDUIT RESTROOMS & CONCESSION STAND - - UNDERSLAB CONDUIT VISITOR SIDE TICKET BOOTH -
Underslab Plumbing Inspection - Commercial Passed 8/23/2021 08/23/2021
THE FOLLOWING AREAS ARE APPROVED
Informational
03/22/2021
- RESTROOM BLDG - - CONCESSION STAND - - OK TO POUR SLAB WHEN READY -
Occupancy Inspection - Codes Commercial Temporary C of O 8/23/2021 8/23/2021 08/23/2021
Miscellaneous Correction
Corrective Action Required
08/23/2021
PROVIDE COVER PLATE BEHIND J BOX AT ELEVATOR PRESS BOX LEVEL
Occupancy Inspection - Fire Temporary C of O 8/23/2021 8/23/2021 08/23/2021
Corrective Action Required
08/23/2021
Add elevator knox box. Post max occupancy sign on third floor observation deck.
Occupancy Inspection - Planning Passed 08/23/2021
Occupancy Inspection - Engineering Temporary C of O 8/23/2021 08/24/2021
Misc
Informational
08/24/2021
This is TCO for the games only. They are still installing the water line. Another punch list will come later after more of the work has been completed. They have sidewalk installed for the fans to be able to get into the stands for seating.
Occupancy Inspection - Water Utilities Passed 09/14/2021
Occupancy Inspection - Fire Passed 9/23/2021 9/23/2021 09/21/2021
Occupancy Inspection - Codes Commercial Temporary C of O 9/23/2021 9/23/2021 09/23/2021
Miscellaneous Correction
Corrective Action Required
08/23/2021
COMPLETE FENCE BETWEEN RESTROOMS & TICKET BOOTH WEST SIDE PROVVIDE VEGETATION BEHIND RESTROOMS WEST SIDE
Water Line - Coliform Test 1 Passed 10/28/2021
Water Line - Hydrostatic Test Passed 10/28/2021
Occupancy Inspection - Engineering Passed 10/28/2021 10/28/2021
Misc
Informational
08/24/2021
This is TCO for the games only. They are still installing the water line. Another punch list will come later after more of the work has been completed. They have sidewalk installed for the fans to be able to get into the stands for seating.
Miscellaneous Correction
Informational
10/28/2021
All punch list items have been completed and a full occupancy can be given for the athletic complex.
Sanitary Sewer Construction Inspection Passed 10/28/2021
Misc
Informational
02/24/2021
2-23-21 3:21pm They have dug up the sanitary service line and it runs under a retaining wall. They will not be able to do any work till the wall is removed. 2-24-21 1:31pm They are digging up for the service lines and are working around a gas line. They should be ready for a inspection at 3pm. 3:27pm They have just cut in the main to install the wyes. They will leave it open for a inspection in the morning. 2-25-21 9:11am They have connected two wyes to the sanitary main that is on the south side of the road. They ran approximately 80’ of service line off of each. They are backfilling with rock. They have tracer wire and tape.
Occupancy Inspection - Codes Commercial Full C of O 11/05/2021
Miscellaneous Correction
Corrective Action Required
09/23/2021
COMPLETE FENCE BETWEEN RESTROOMS & TICKET BOOTH WEST SIDE PROVVIDE VEGETATION BEHIND RESTROOMS WEST SIDE
Documents & Images
Date Uploaded File Type Document Name
10/05/2020 Application Form LSHS - Commercial Permit Application
10/12/2020 Plans Lees Summit High School - VOL1 - Drexel Bid Set - 2020 09 28
10/12/2020 Engineer Report/Study LSR7 Athletic Facilites - Structural Calcs - 100220
10/12/2020 Letter Letter of Code Modification Request - 2020-10-1 Athletics CMR
10/12/2020 LSHS_Code Modification Request COMMERCIAL
10/12/2020 Letter LSHS_Analysis_Stadium Restrooms_2020_09_30
10/12/2020 Drawing LSHS_Travel Distance Diagrams
10/12/2020 Application Form LSR7 LSHS - FDP App&Affidavit - 10052020
10/12/2020 Application Form LSR7 LSHS - FDP App Checklist - 10052020
10/12/2020 Plans LSR7 - Lee's Summit High School Boundary Description - 10062020
10/12/2020 Plans 20201009 LSHS Master Drainage Plan
10/12/2020 Plans H-E100P - PHOTOMETRIC LIGHTING PLANS
10/12/2020 Specifications Lee's Summit High School_lighting cut sheets
10/12/2020 Specifications Lee's Summit High Schools - Specifications - Vol 2
10/12/2020 Specifications Lee's Summit High Schools - Specifications - Vol 1
10/14/2020 Email RE Lee's Summit High Schools Project Valuations
10/19/2020 Letter Fire Building Plan Review
10/23/2020 Letter DS P/R Corrections Document
11/05/2020 Email Food Establishment Remodel Plan Review - Approved FTG 0001670
11/10/2020 Lee's Summit High Schools Addenda Narratives
11/10/2020 LSHS report - PRCOM20203513 - Response
11/10/2020 Lee's Summit High Schools - Specifications - Vol 2 - REV 2020 11 09
11/10/2020 Lee's Summit High Schools - Specifications - Vol 1 - REV 2020 11 09
11/10/2020 Plans Lees Summit High School - VOL1 - with Addenda - 2020 11 03
11/11/2020 Letter Fire Building Plan Review
11/11/2020 Code Mod Request CMR for LSHS - approved
01/14/2021 Receipt Receipt for transaction: 2021-000208
01/14/2021 Approved Plans Approved Lees Summit High School
01/14/2021 Letter DS Building Permit
01/20/2021 Letter INSPECTION SUMMARY
01/22/2021 Letter INSPECTION SUMMARY
01/25/2021 Letter License Tax Not Applicable
01/25/2021 Letter INSPECTION SUMMARY
01/25/2021 Letter License Tax Not Applicable
01/26/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
02/02/2021 12 inch.jpg
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
02/05/2021 Water service line.jpg
02/05/2021 Letter INSPECTION SUMMARY
02/08/2021 Letter INSPECTION SUMMARY
02/09/2021 Letter INSPECTION SUMMARY
02/10/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/24/2021 Sanitary line .jpg
02/24/2021 Maxadaptor.jpg
02/24/2021 Letter INSPECTION SUMMARY
02/25/2021 Sanitary tie in.jpg
02/25/2021 Waterline .jpg
02/25/2021 Letter INSPECTION SUMMARY
03/01/2021 Letter INSPECTION SUMMARY
03/02/2021 Letter INSPECTION SUMMARY
03/02/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/04/2021 Letter INSPECTION SUMMARY
03/04/2021 Letter INSPECTION SUMMARY
03/05/2021 Letter INSPECTION SUMMARY
03/05/2021 Letter INSPECTION SUMMARY
03/05/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
03/09/2021 Letter INSPECTION SUMMARY
03/10/2021 Letter INSPECTION SUMMARY
03/10/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/12/2021 Letter INSPECTION SUMMARY
03/15/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY
03/18/2021 Letter INSPECTION SUMMARY
03/19/2021 Letter INSPECTION SUMMARY
03/19/2021 Letter INSPECTION SUMMARY
03/22/2021 Letter INSPECTION SUMMARY
03/22/2021 Letter INSPECTION SUMMARY
03/22/2021 Letter INSPECTION SUMMARY
03/24/2021 Letter INSPECTION SUMMARY
03/25/2021 sample 1 LS High School
03/25/2021 Letter INSPECTION SUMMARY
03/26/2021 LS School sample 2
03/26/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/29/2021 Letter INSPECTION SUMMARY
03/30/2021 Letter INSPECTION SUMMARY
03/31/2021 Letter INSPECTION SUMMARY
04/05/2021 Letter INSPECTION SUMMARY
04/06/2021 Letter INSPECTION SUMMARY
04/06/2021 Letter INSPECTION SUMMARY
04/07/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/21/2021 Letter INSPECTION SUMMARY
04/26/2021 Letter INSPECTION SUMMARY
05/13/2021 Letter INSPECTION SUMMARY
05/20/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/27/2021 Letter INSPECTION SUMMARY
06/04/2021 Letter INSPECTION SUMMARY
06/04/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
06/14/2021 Letter Fire (Alarm) Plan Review Notice
06/14/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/21/2021 Letter INSPECTION SUMMARY
06/21/2021 Letter INSPECTION SUMMARY
06/24/2021 Letter INSPECTION SUMMARY
06/24/2021 Letter INSPECTION SUMMARY
07/19/2021 Letter INSPECTION SUMMARY
07/20/2021 Engineer Report/Study ENGINEER REPORT
07/22/2021 Waterline going down the hill of the drive.jpg
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter INSPECTION SUMMARY
08/23/2021 Letter Codes Temporary Certificate of Occupancy
08/23/2021 Letter Fire Loss Reduction Form
08/24/2021 Letter INSPECTION SUMMARY
08/24/2021 Letter INSPECTION SUMMARY
08/25/2021 Letter INSPECTION SUMMARY
09/15/2021 Letter INSPECTION SUMMARY
09/21/2021 Letter Fire Loss Reduction Form
09/22/2021 Letter Fire Loss Reduction Form
09/23/2021 Letter Codes Temporary Certificate of Occupancy
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
10/28/2021 Letter INSPECTION SUMMARY
11/05/2021 Letter Field Certificate of Occupancy
11/05/2021 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
