Summary

PRSUBD20220125
Public Infrastructure
Final Acceptance
LOWKAP LLC
DEVELOPMENT COMPLETE
LEE'S SUMMIT COMMERCE CENTER (LOGISTICS) - PUBLIC STREET, STORM, SANITARY AND WATER
01/10/2022
03/09/2022
06/27/2024
Locations
Contacts
LOWKAP LLC, Address:12709 WOODWARD ST
KADEAN CONSTRUCTION, Address:3668 S GEYER RD STE 100, Phone:(636) 305-0099
JOSH MOORE, Address:KADEAN CONSTRUCTION, Phone:(816) 708-1199
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 01/10/2022 03/07/2022
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110071-Site Grading Fee $64,896.61 $64,896.61 Paid 03/07/2022
$64,811.61
9110068-Storm Sewer Inspection Fee $18,105.00 $18,105.00 Paid 06/27/2022
91100C8-Sanitary Sewer Insp Fees $360.00 $360.00 Paid 06/27/2022
9110081-Paved Surface Inspection Fee $61,403.67 $61,403.67 Paid 06/27/2022
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 06/27/2022
9110071-Site Grading Fee $26,575.72 $26,575.72 Paid 06/27/2022
$91,472.33
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 11/15/2023
9110079-After Hours Inspection (Building Codes)(Per Hour) $25.00 $25.00 Paid 11/15/2023
9110079-After Hours Inspection (Building Codes)(Per Hour) $100.00 $100.00 Paid 11/15/2023
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Partial 03/23/2022
Misc
Informational
03/23/2022
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Grading/Excavation/Fill Inspection Partial 03/29/2022
Misc
Informational
03/29/2022

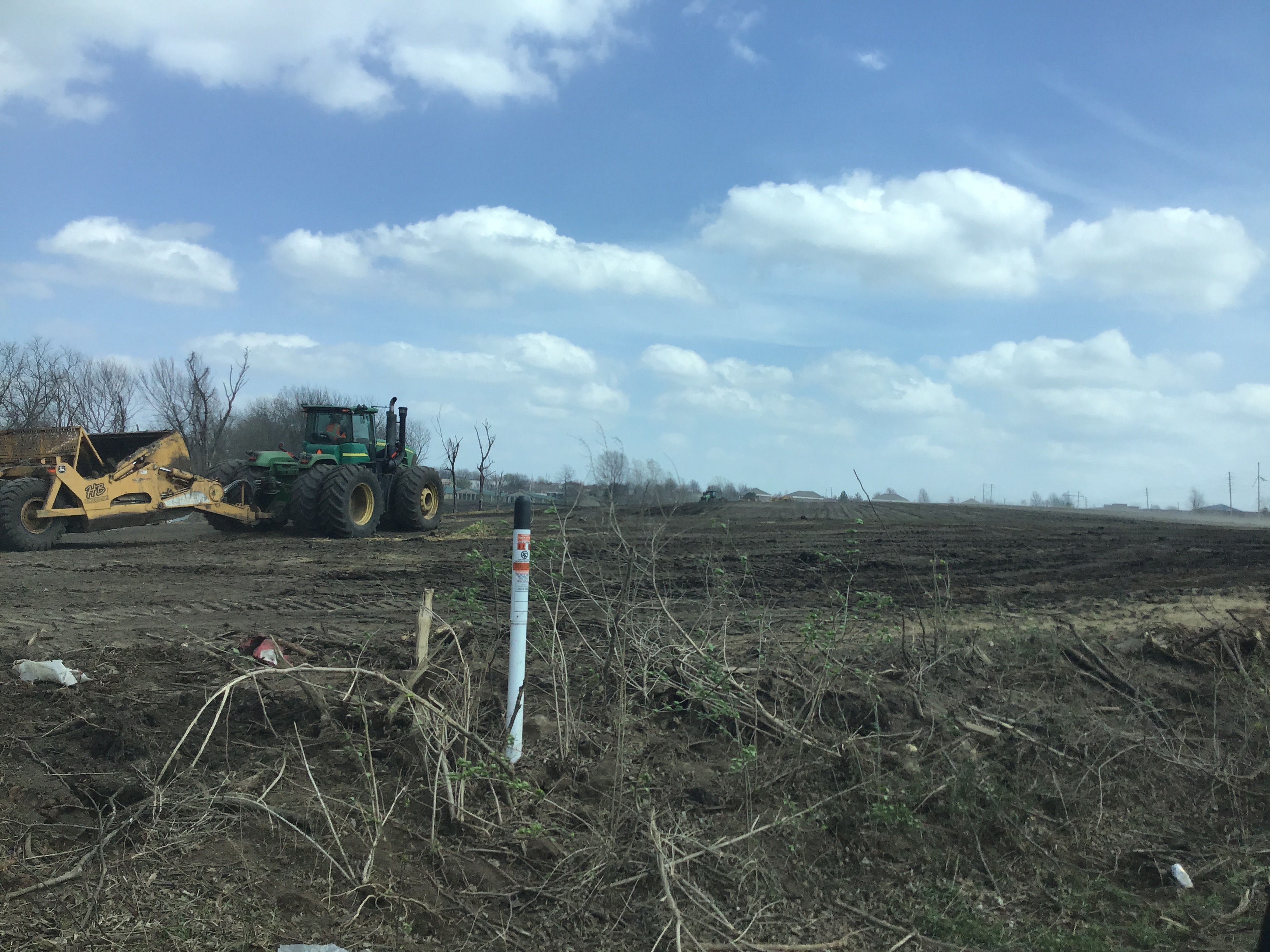

03/29/22 (KADEAN) Contractor has continued to grade site for the pass few weeks. 04/01/22 (KADEAN) Contractor was able to continued grading after the inclement weather of the last days. 04/05/22 (MH Construction)has continued grading and excavation of site. They will begin installing basin according to plans soon. 04/07/22 (MH Construction) Contractor was able to continued work of grading site and creating basins. Work was suspended yesterday due to the rainy weather conditions. 04/08/22 (MH Construction) Contractor continued excavation of site as per plans. 04/11/22 (MH Construction) Contractor continued to excavation of site as per plans. Contractor continued to construct basin, berms and grade site. 04/25/22 (MH Construction) Contractor continued to excavation of site.
Site Visit Partial 04/05/2022
Misc
Informational
04/05/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right of Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 04/07/22 Thursday B&H Construction Right of Way Inspector Nick Ross found out that the snagged communication line was Time Warner’s 04/06/22 Wednesday. 05/02/22 Monday No work due to rain. 05/09/22 Contractor continued grading site. 06/28/22 Tuesday Met with Steve of Central Plumbing about the up coming installation of storm line on city street. Contractor will use rock and AB3 on street crossing. Note: Changes in soil textures occur often on this site. I talked with Olsson about testing results for underground utilities.
Erosion Control Inspection Partial 05/05/2022
Misc
Informational
03/23/2022
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
05/05/2022
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions. 05/06/2022 Friday (HB Const./KADEAN) Silting fencing still not corrected conditions of site makes it (severely saturation grounds ) difficult to reach areas. The weekend will dry out site condition to make the appropriate corrections.
Grading/Excavation/Fill Inspection Partial 05/12/2022

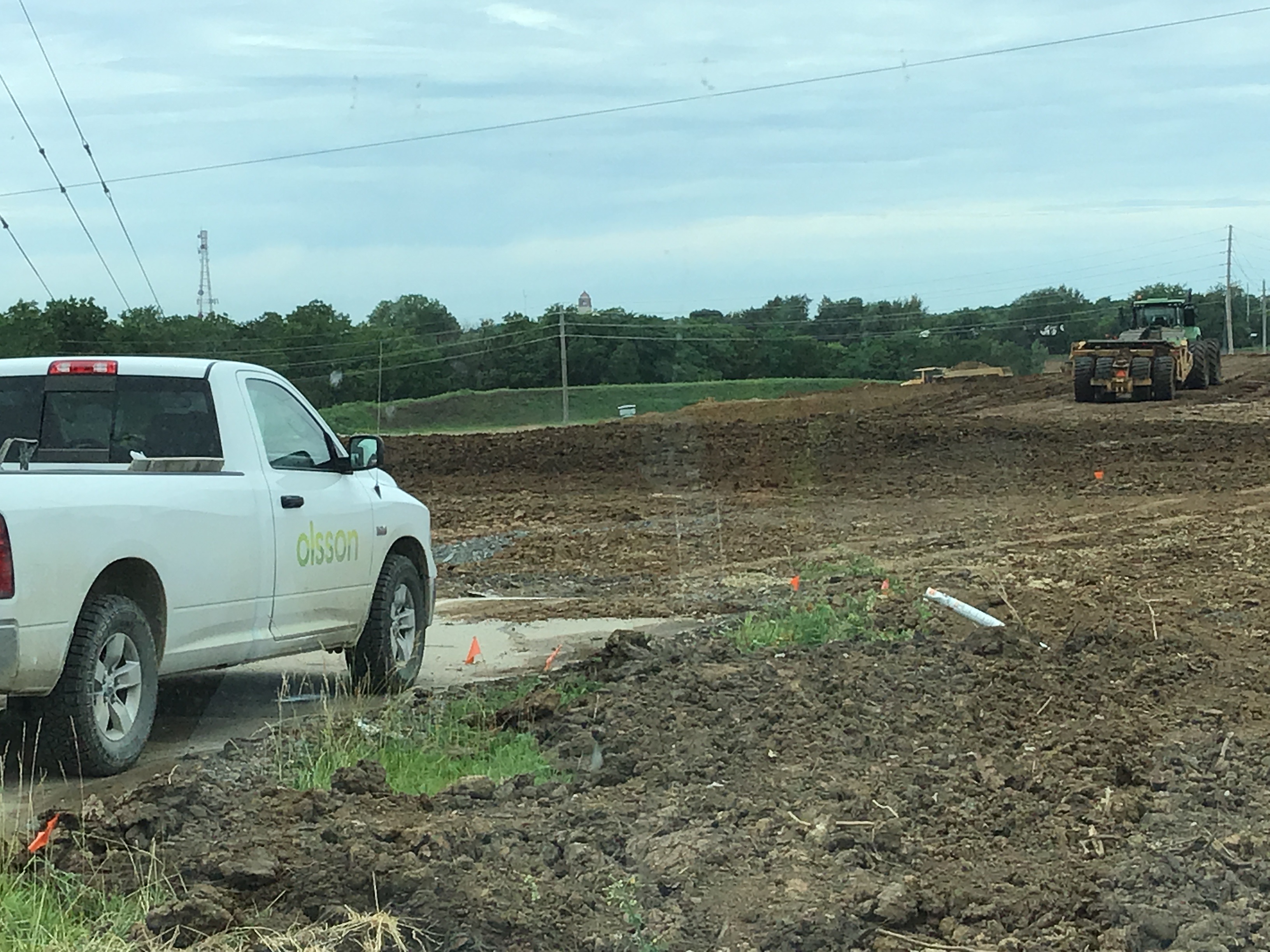

Misc
Informational
03/29/2022
03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
05/12/2022
5-12-22 AN crew is continuing to grad site
Erosion Control Inspection Partial 05/12/2022
Misc
Informational
05/05/2022
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
05/05/2022
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
05/12/2022
5-12-22 AN the silt fence that i did see looked in good working order
Grading/Excavation/Fill Inspection Partial 05/17/2022
Misc
Informational
05/12/2022
03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
05/12/2022
5-12-22 AN crew is continuing to grad site 5-17-22 AN crew still doing grading silt fencing maintain. 06/16/22 Continues grading when weather permit site.
Grading/Excavation/Fill Inspection Partial 05/18/2022
Misc
Informational
05/17/2022
03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
05/17/2022
5-12-22 AN crew is continuing to grad site 5-17-22 AN crew still doing grading 5-18-22 AN no grading being done today do to rain last night 5/20/22 Friday (HB Construction) Continued to grade site. It appeared that drone was on site survey grade work. 5/23/22 Monday (HB Construction) Continued to grade site. 06/21/22 Tuesday (HB Construction) Continued to grade site as per project plans. 06/22/22 Wednesday (HB Construction) Continued grading of site as per project plans. 06/27/22 Monday (HB Construction) Continued grading and excavation of site contractor breaking rock on the Northwest portion of project. 06/30/22 Thursday (HB Construction) Continued grading and excavation still breaking rock with heave equipment on the Northwest portion of project.
Water Line - Construction Inspection Passed 06/13/2022
Misc
Informational
06/10/2022
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
06/13/2022
06/13/22 Monday (Central Plumbing) Contractor has installed two oversized 6” sleeves with caps on the abandoned North end and dead end South end of water main. Contractor installed cookie in the abandoned main side to stop back thrust of water main from main being dead ended. Water was restored by 11:15AM.
Grading/Excavation/Fill Inspection Partial 07/05/2022
Misc
Informational
05/18/2022
03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
05/18/2022
5-12-22 AN crew is continuing to grad site 5-17-22 AN crew still doing grading 5-18-22 AN no grading being done today do to rain last night
Misc
Informational
07/05/2022

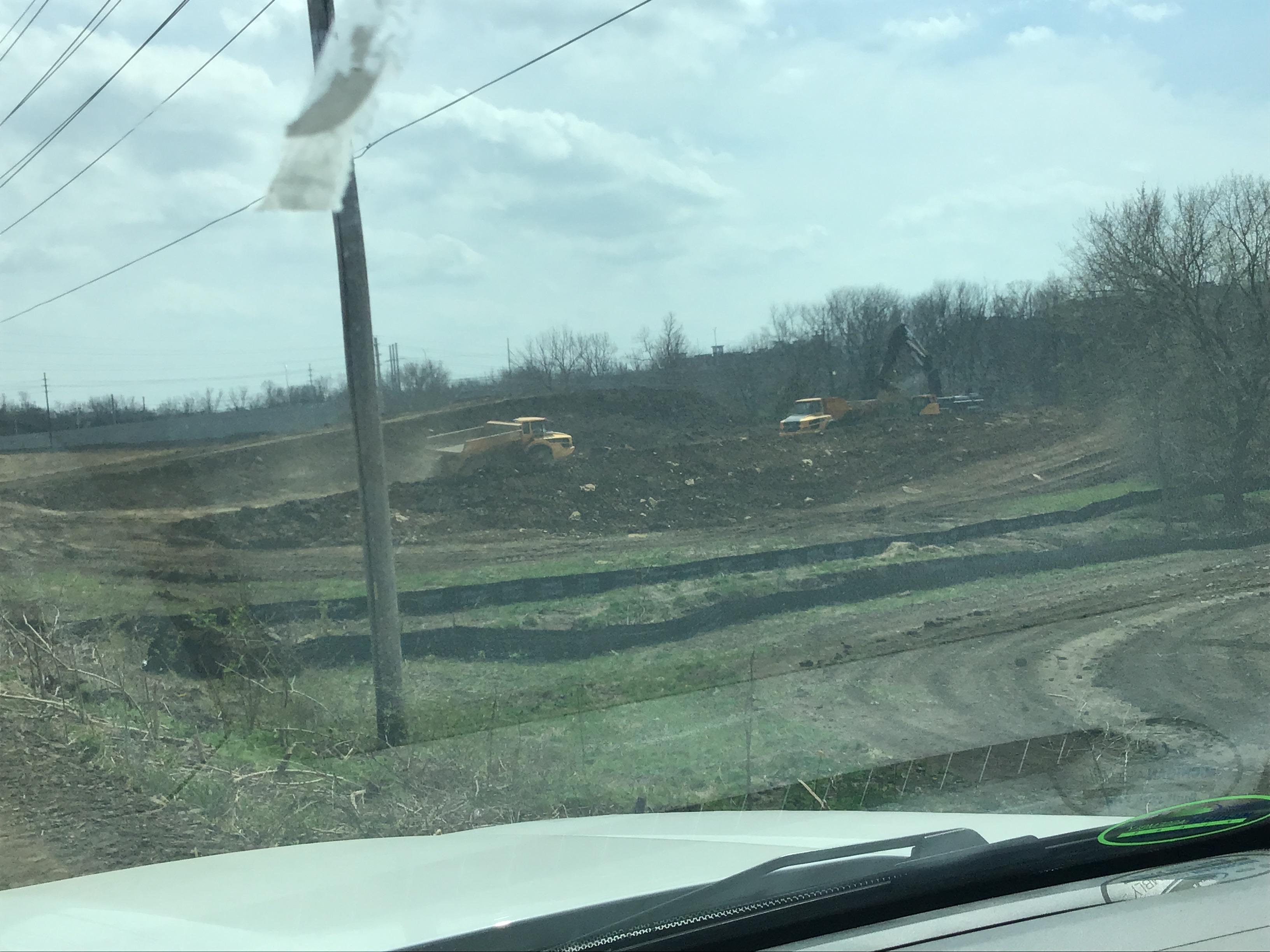

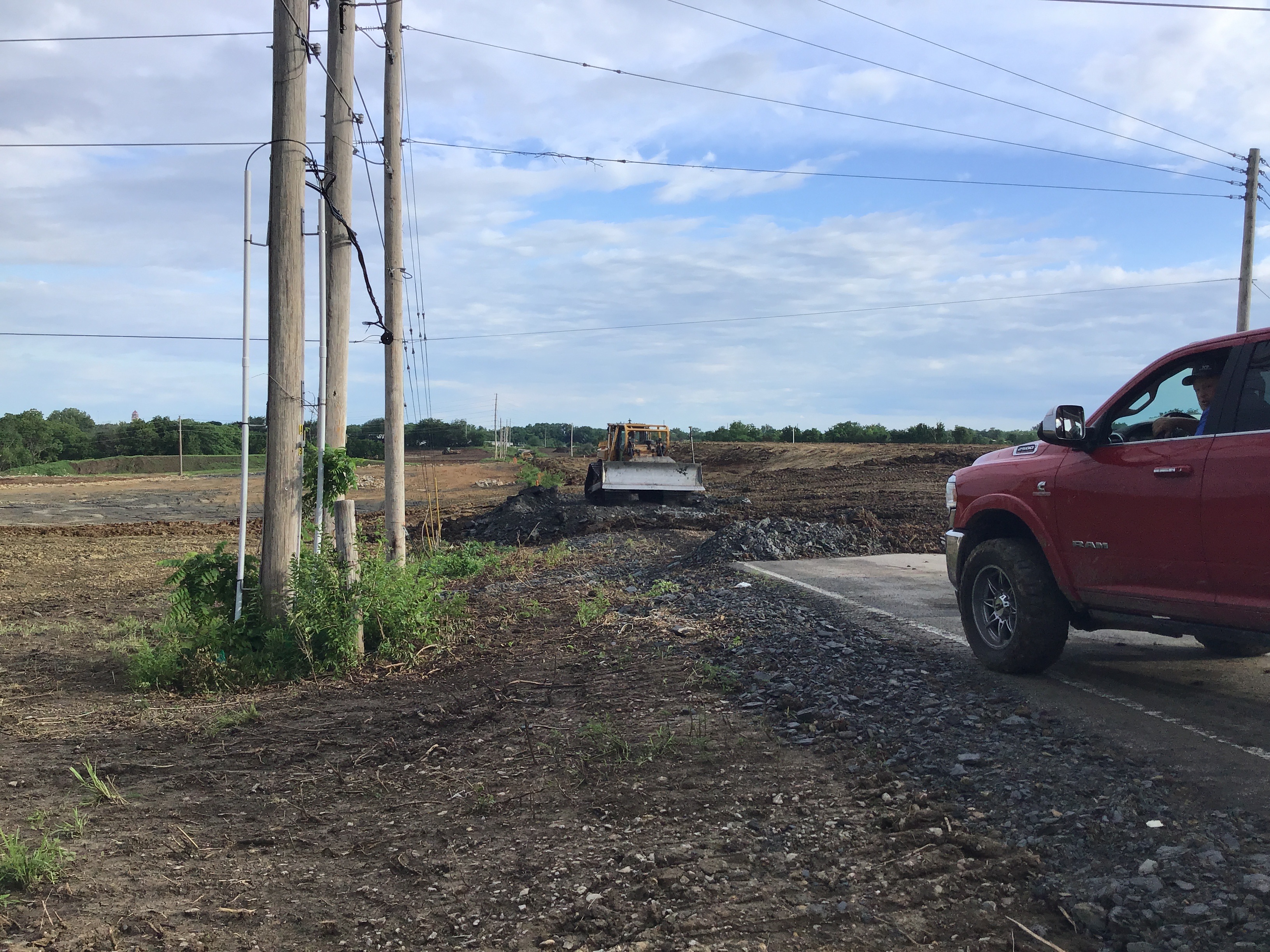

7-5-22 AN crew is continuing to grade area and also appears that they are drilling to blast rock 07/07/22 Thursday (HB Construction) Continues to grade site as per project plans. 07/13/22 Wednesday JMJ mass grading continues on site.
Storm Sewer Construction Inspection Partial 07/06/2022
Misc
Informational
07/06/2022

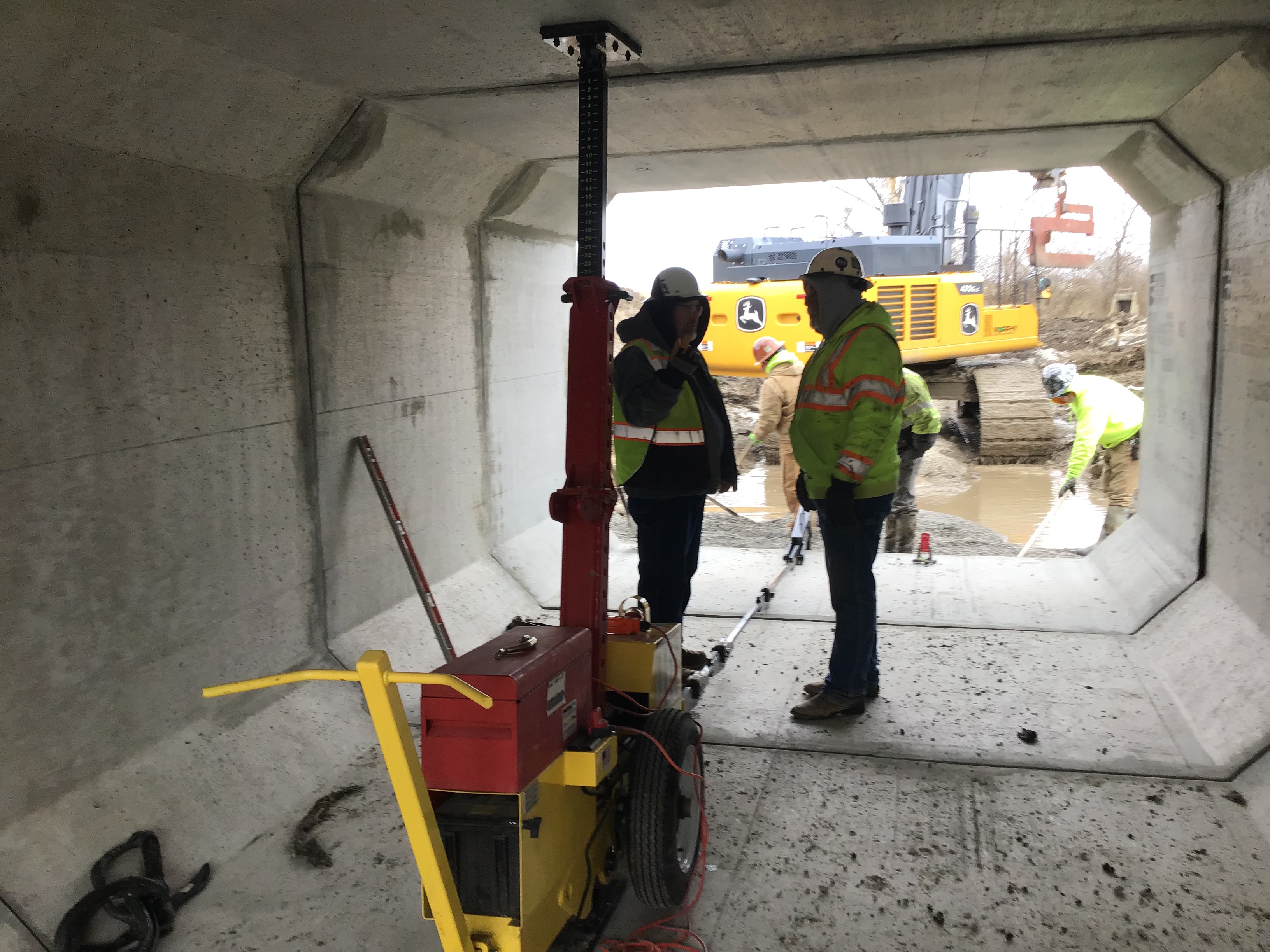

CI =Curb Inlet=Storm Box 07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from Storm box B-3 (5’x5’)to Junction box B-4(5x4) 07/07/22 Thursday ( Central Plumbing ) Contractor continued the installation of RCP along Line #B 10:00AM. Contractor installing 36” RCP from storm box B-4 to B-5(5’x5’) bases approximately 120’ plus additional 20’ after B-5. 07/08/22 Friday ( Central Plumbing ) Contractor continued installation of 36” RCP pipe from just after B-5 towards B-6 which is approximately 393’ between the two storm boxes. CI = Curb Inlet B-5 (5’x5’)to E-1 (6’x3’) 55 LF of 15” RCP @ 1.18%. 07/11/22 Monday ( Central Plumbing ) Contractor continued installation of 36” RCP pipe heading toward B-6. Installing of B-6 base will be done by Noon today. Contractor installed approximately 250’ of 36” today. Storm line “F” was installed @ Sta: 27+38.00 across future road from CI 5’x5’ ( Northside) to 6’x3’ ( Southside ) with 55’ of 15’ RCP between the boxes. 7/12/22 Tuesday ( Central Plumbing/Steve ) Installed approximately 120’ of 36” RCP from CI base B6 to B7 contractor backfilled excavation. Contractor began to pour collars on CI base B4, B5, B6, E1 & F1. 07/13/22 Wednesday JMJ ( Central Plumbing/ Steve ) Installed approximately 120’ of 36” RCP from CI base B7 to B8 contractor backfilled excavation also mid section was placed on B8. Contractor will continue to install 36” RCP storm line “B” after B8 to B9 9:55AM. All CI are (stack out) from B5 to B8. Approximately 120’ of 36” RCP from B8 to B9. 07/15/22 Friday JMJ ( Central Plumbing/ Steve ) Contractor poured collars and inverts on storm boxes also the 15” RCP was installed from B9 to B10 yesterday. Invert where not complete a B9, 10 or G1. 07/18/22 Monday JMJ ( Central Plumbing ) Contractor installed approximately 100’ of 42” RCP from B2 to B3 . 07/20/22 Wednesday JMJ ( Central Plumbing ) Contractor installing approximately 55 of 15” RCP storm line G1 from B3.
Storm Sewer Construction Inspection Partial 07/14/2022
Misc
Informational
07/06/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
07/14/2022
7-14-22 RH. 36” Storm B-9 to G-1 approximately 55’ was ran and filled over.
Storm Sewer Construction Inspection Partial 07/14/2022
Misc
Informational
07/14/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
07/14/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Erosion Control Inspection Partial 07/14/2022
Misc
Informational
05/12/2022
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
05/12/2022
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
05/12/2022
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
07/14/2022
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
07/25/2022
07/25/07 Monday JMJ Erosion control appears to be in place and in working order.
Fire Line Construction Inspection Partial 07/20/2022
Misc
Informational
07/20/2022
07/20/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor began the installation of the fire lines. The first part of fire line were installed on the NE side of future building. All thread steel was installed @ the 90 deg bends concrete will be poured sometime this week. 07/21/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor poured backing blocks behind 5 fire line shaft areas on the Northside of purposed building structure. 2/10” located on the NE corner or side by side and 1 / 8” on the NW corner of structure. The other two 8” fire line shaft or on the Eastside of building structure. Contractor installed one piece of pipe and 90 deg bend with restraints and piping to extend above the floor level of structure.
Storm Sewer Construction Inspection Partial 09/01/2022
Misc
Informational
07/14/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
07/14/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
09/01/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2.
Storm Sewer Construction Inspection Partial 09/02/2022
Misc
Informational
09/01/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
09/01/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
09/01/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan.
Storm Sewer Construction Inspection Partial 09/06/2022
Misc
Informational
09/02/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
09/02/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
09/02/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Storm - Pipe Partial 09/26/2022
Misc
Informational
09/26/2022

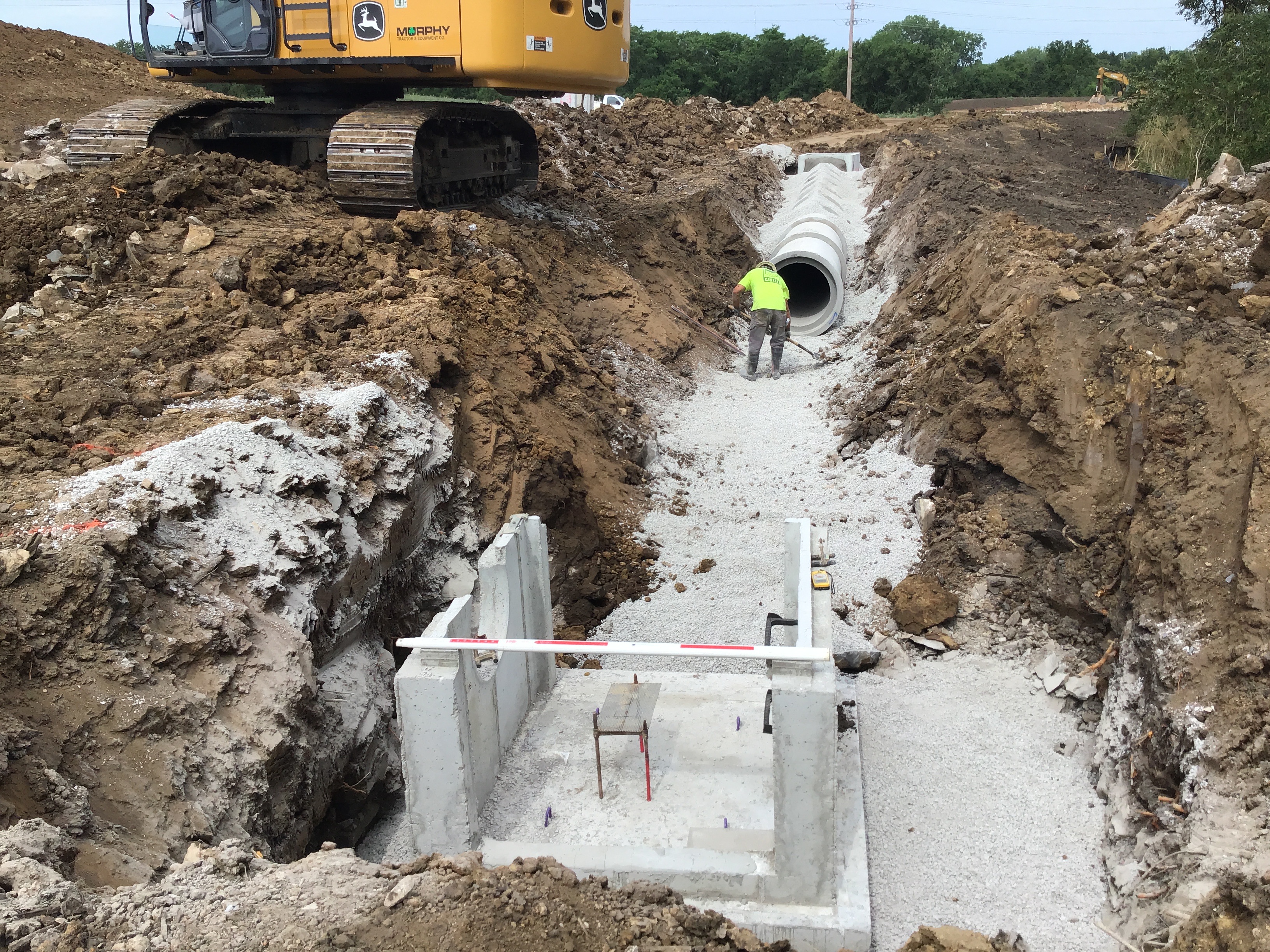

On Monday, 9-26-2022 Plumbing Contractor placed 15” HDPE pipe for G line. Contractor installed approx. LF of pipe.

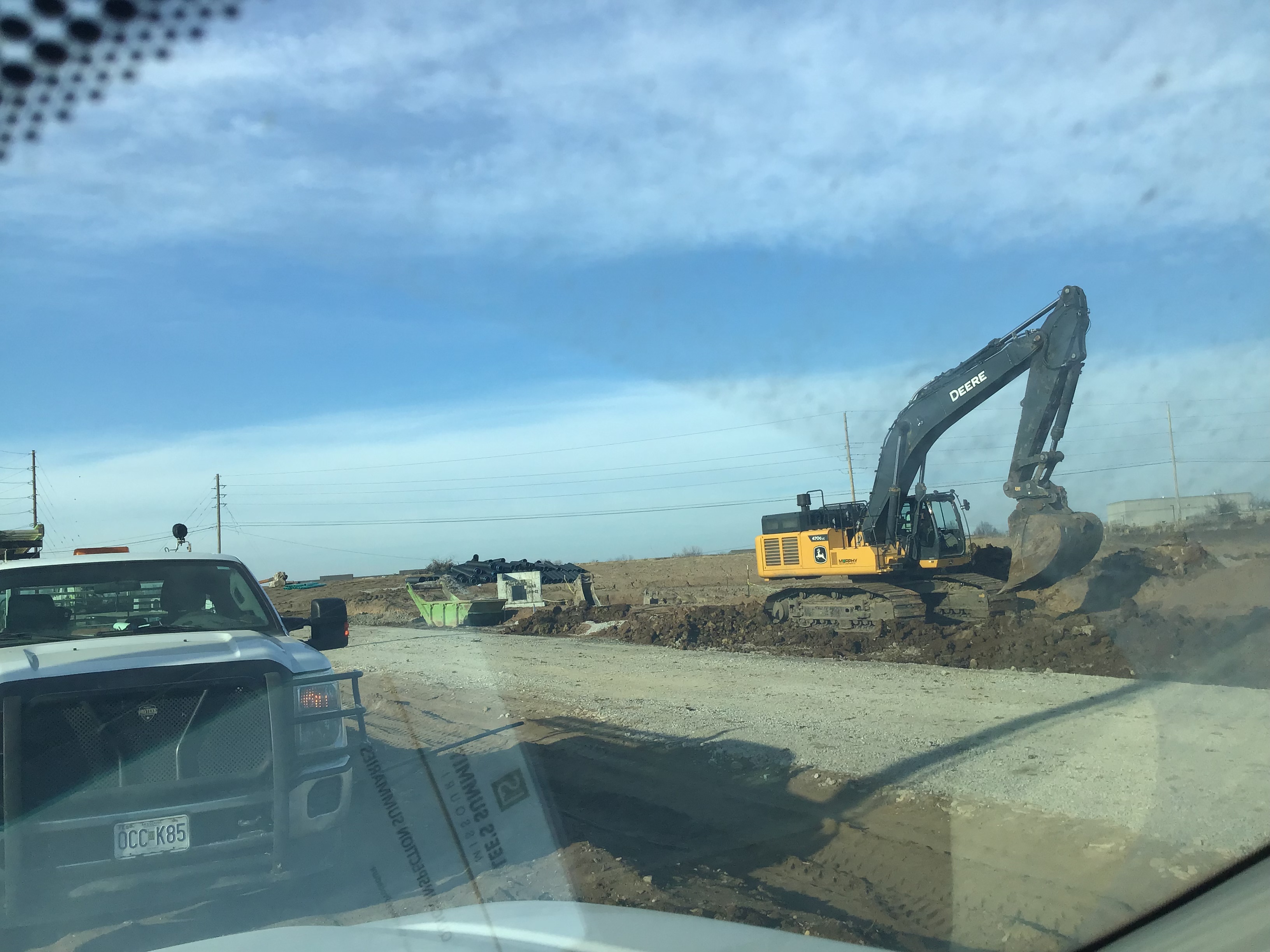

Grading/Excavation/Fill Inspection Partial 09/26/2022
Misc
Informational
07/05/2022
03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
07/05/2022
5-12-22 AN crew is continuing to grad site 5-17-22 AN crew still doing grading 5-18-22 AN no grading being done today do to rain last night
Misc
Informational
07/05/2022
7-5-22 AN crew is continuing to grade area and also appears that they are drilling to blast rock
Misc
Informational
09/26/2022
On Monday 9-26-2022. K&B Excavating moving dirt fill and filling areas at various locations throughout project.
Fire Line Construction Inspection Partial 09/28/2022
Misc
Informational
07/20/2022
07/20/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor began the installation of the fire lines. The first part of fire line were installed on the NE side of future building. All thread steel was installed @ the 90 deg bends concrete will be poured sometime this week.
Misc
Informational
09/28/2022
On Wednesday 9-28-2022. Miller Plumbing worked in vault area installing 3” copper line for meter installation. ( Tom Taylor)
Storm Sewer Construction Inspection Partial 09/28/2022
Misc
Informational
09/06/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
09/06/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
09/06/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
09/28/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Storm Sewer Construction Inspection Partial 12/08/2022
Misc
Informational
09/28/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
09/28/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
09/28/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
09/28/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/08/2022

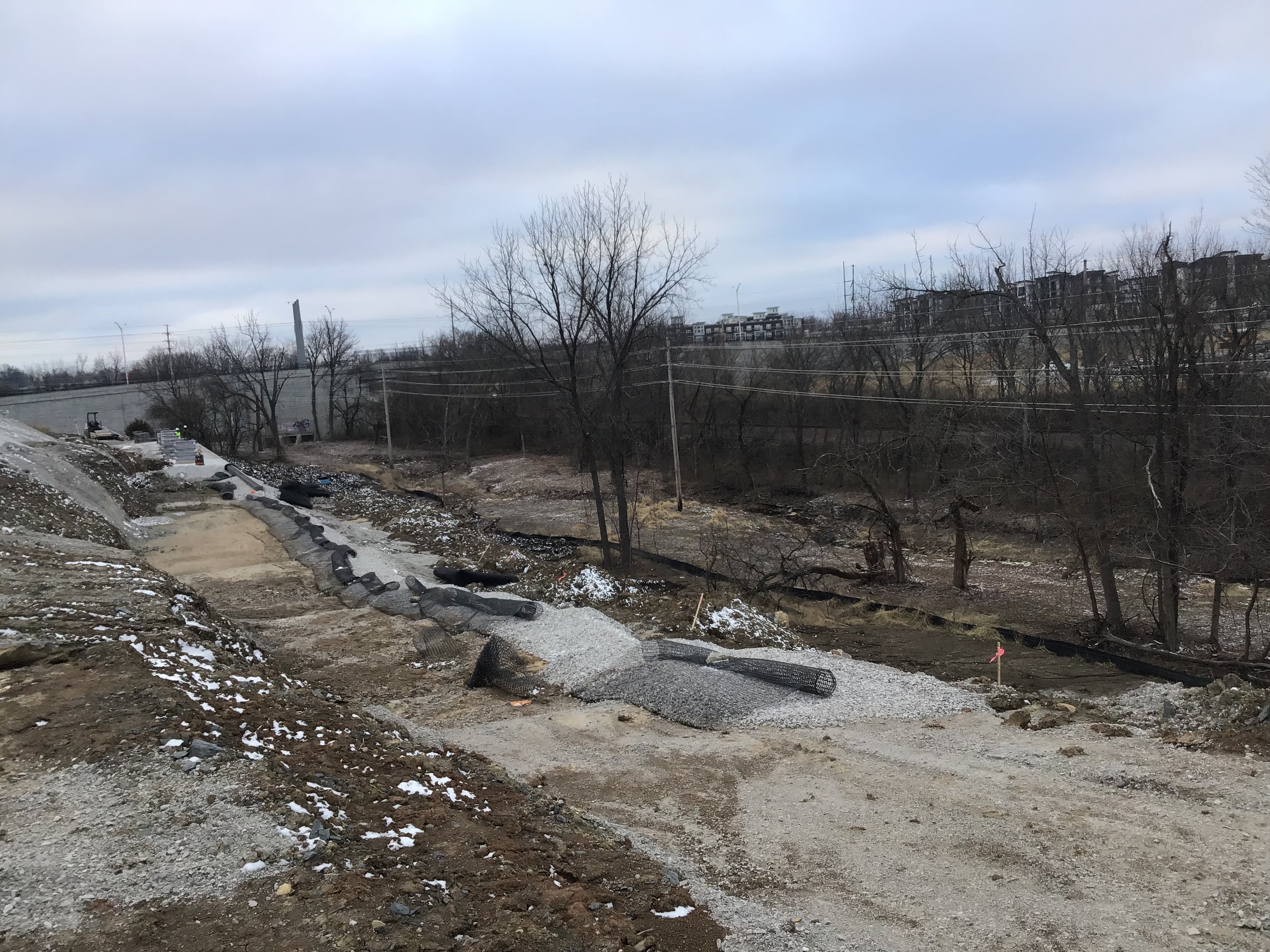

12/08/22 Thursday JMJ ( Central Plumbing -Kurt ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday.
Storm Sewer Construction Inspection Partial 12/09/2022
Misc
Informational
12/08/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/08/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/08/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/08/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/08/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X*’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck.
Site Visit Partial 12/09/2022
Misc
Informational
04/05/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. Third party inspector report will be sent to the City of Lee’s Summit.
Storm Sewer Construction Inspection Partial 12/12/2022
Misc
Informational
12/09/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/09/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/09/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/09/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/09/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. (Terracon)
Miscellaneous PWORKS Inspection Partial 12/12/2022
Misc
Informational
12/12/2022

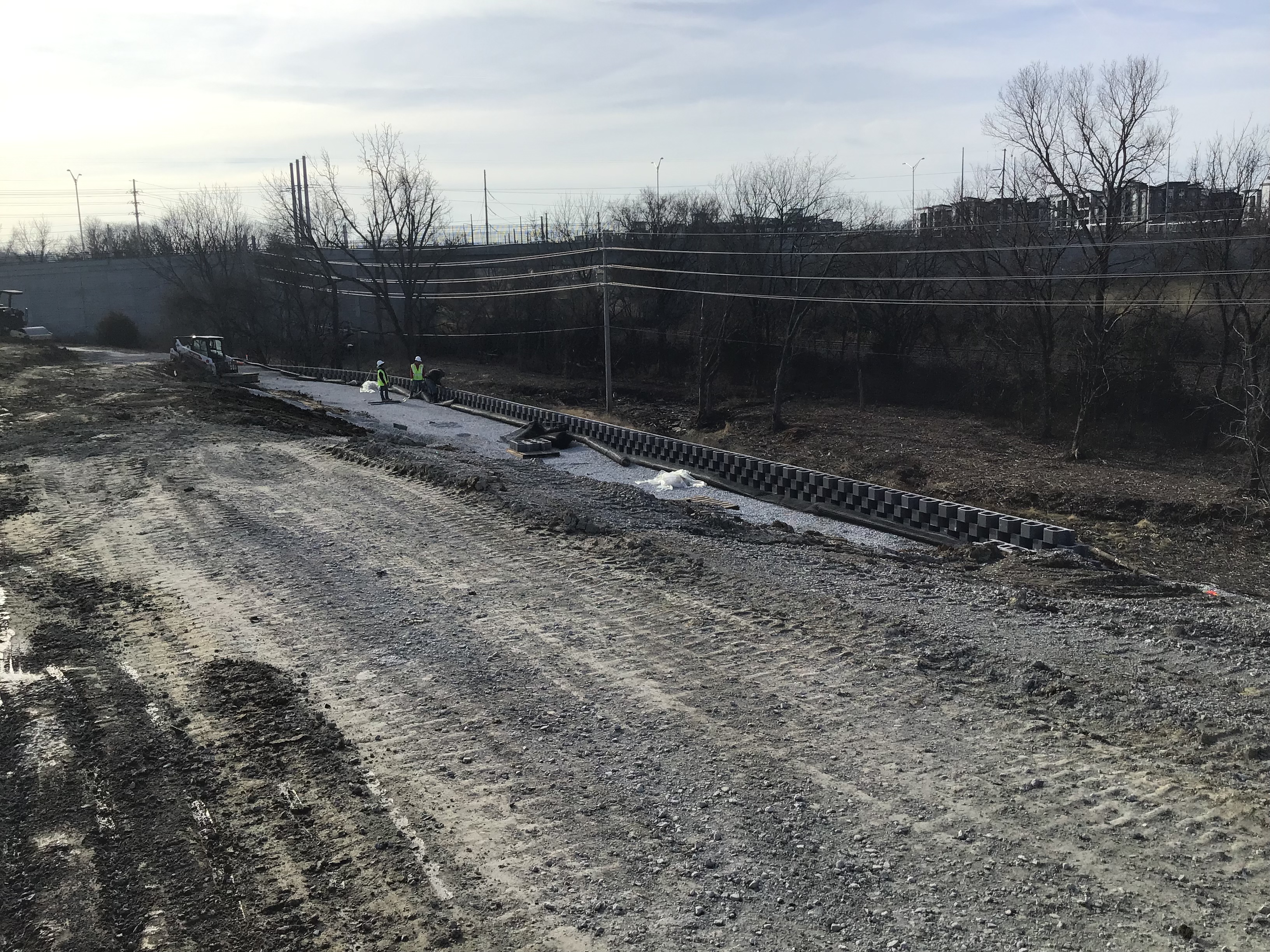

12/12/22 Monday JMJ ( BC Hardscapes ) Contractor installed second layer of gravel and Geogrid for the retaining wall.
Storm Sewer Construction Inspection Partial 12/15/2022
Misc
Informational
12/12/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/12/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/12/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/12/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/12/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together ( a come along ).
Storm Sewer Construction Inspection Partial 12/15/2022
Misc
Informational
12/15/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/15/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/15/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/15/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/15/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ).
Site Visit Partial 12/15/2022
Misc
Informational
12/09/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall.
Storm Sewer Construction Inspection Partial 12/16/2022
Misc
Informational
12/15/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/15/2022

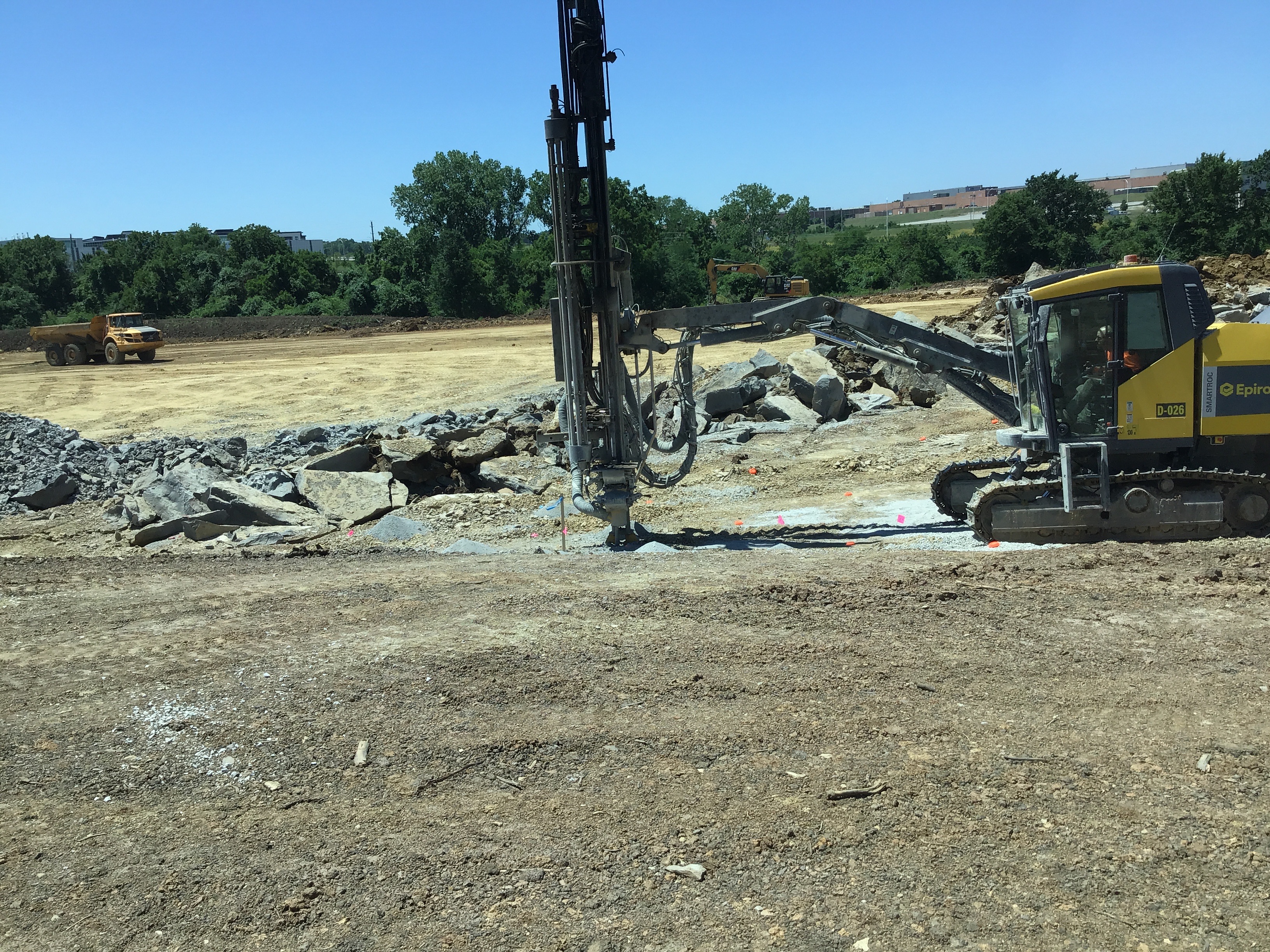

7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/15/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/15/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/15/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue.
Storm Sewer Construction Inspection Partial 12/19/2022
Misc
Informational
12/16/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/16/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/16/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/16/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/16/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. I talked with Steve of Central Plumbing and the storm was completed on Friday. Today contractor will focus on grouting & rapping the section that are out of tolerance.
Storm Sewer Construction Inspection Partial 12/19/2022
Misc
Informational
12/19/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/19/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/19/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/19/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/19/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance.
Storm Sewer Construction Inspection Partial 12/20/2022
Misc
Informational
12/19/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/19/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/19/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/19/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/19/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B.
Site Visit Partial 12/20/2022
Misc
Informational
12/15/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall.
Storm Sewer Construction Inspection Partial 12/21/2022
Misc
Informational
12/20/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/20/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/20/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/20/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/20/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight.
Site Visit Partial 12/21/2022
Misc
Informational
12/20/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall. 12/21/22 Wednesday JMJ ( BC Hardscape Landscape Construction ) Continued installation of foundation for retaining wall.
Retaining Wall Inspection Partial 12/29/2022
Misc
Informational
12/29/2022
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ).
Retaining Wall Inspection Partial 12/30/2022
Misc
Informational
12/29/2022
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to due some light work and more modular brick were delivered for retaining wall.
Retaining Wall Inspection Partial 01/03/2023
Misc
Informational
12/30/2022
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/22 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night.
Retaining Wall Inspection Partial 01/05/2023
Misc
Informational
01/03/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall.
Retaining Wall Inspection Partial 01/06/2023
Misc
Informational
01/05/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall.
Retaining Wall Inspection Partial 01/09/2023
Misc
Informational
01/06/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall.
Storm Sewer Construction Inspection Partial 01/09/2023
Misc
Informational
12/21/2022
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
12/21/2022
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
12/21/2022
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
12/21/2022
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
12/21/2022
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project.
Retaining Wall Inspection Partial 1/10/2023 1/10/2023 01/10/2023
Misc
Informational
01/09/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ).
Retaining Wall Inspection Partial 1/11/2023 1/11/2023 01/11/2023
Misc
Informational
01/10/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall.
Retaining Wall Inspection Partial 1/13/2023 1/13/2023 01/13/2023
Misc
Informational
01/11/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12.23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall.
Storm Sewer Construction Inspection Partial 1/13/2023 1/13/2023 01/13/2023
Misc
Informational
01/09/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/09/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/09/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/09/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/09/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed.
Storm Sewer Construction Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/13/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/13/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/13/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/13/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/13/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line.
Storm Sewer Construction Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/16/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/16/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/16/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/16/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/16/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures.
Retaining Wall Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
01/13/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12/23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/16/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall.
Grading/Excavation/Fill Inspection Partial 1/16/2023 1/16/2023 01/16/2023
Misc
Informational
09/26/2022

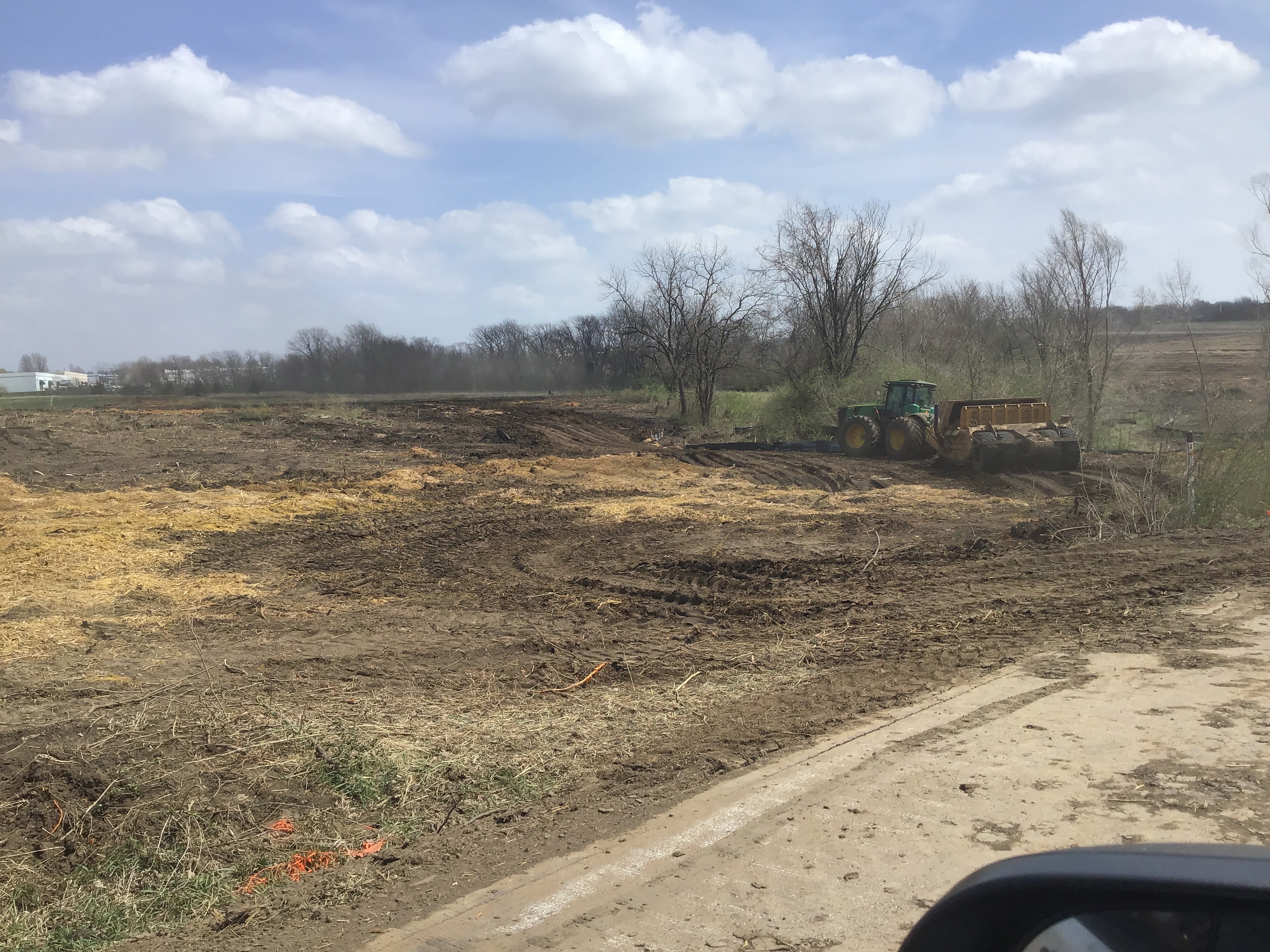

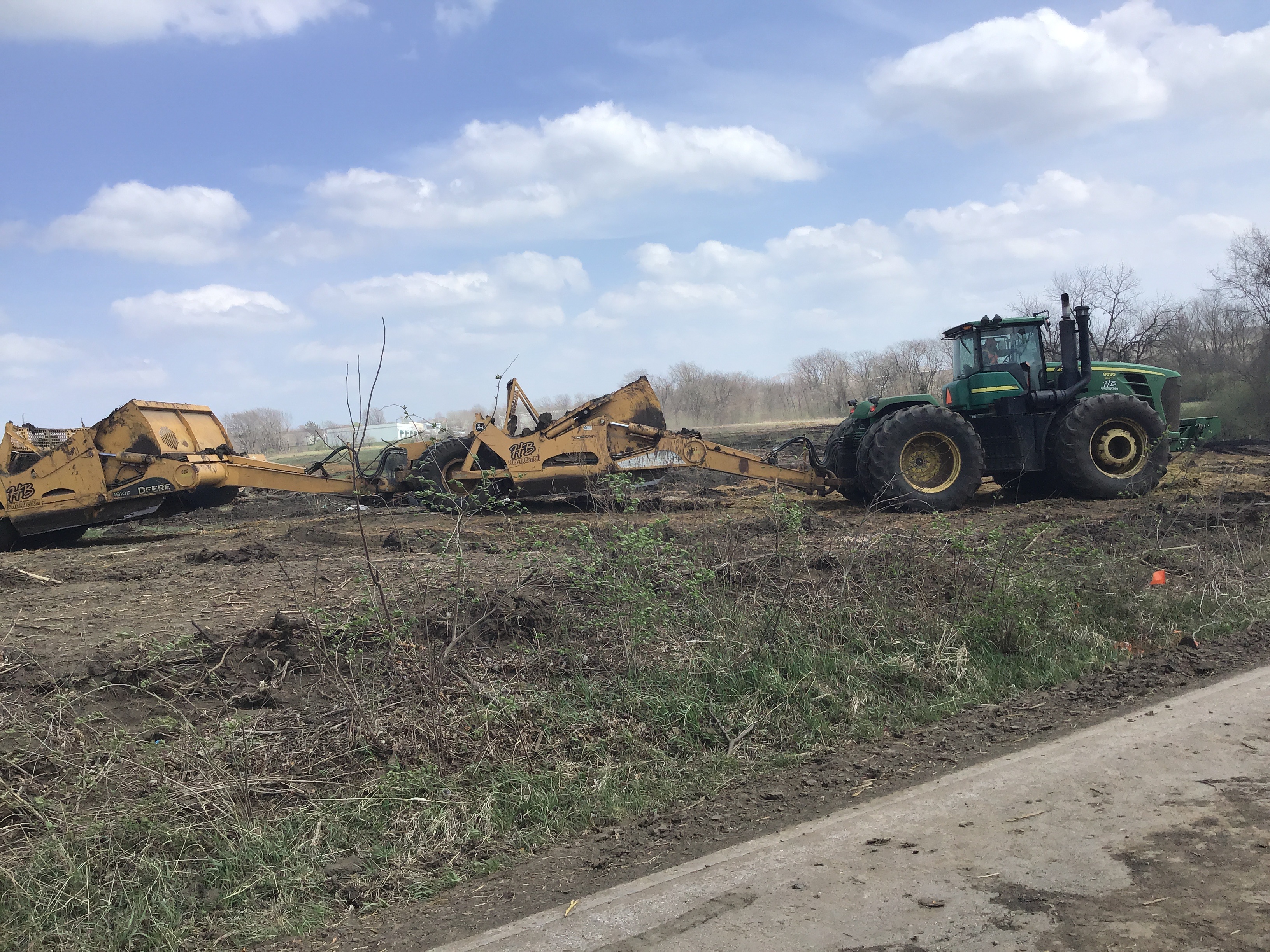

03/29/22 (Rob Geist) Contractor has continued to grade site for the pass few weeks.
Misc
Informational
09/26/2022
5-12-22 AN crew is continuing to grad site 5-17-22 AN crew still doing grading 5-18-22 AN no grading being done today do to rain last night
Misc
Informational
09/26/2022
7-5-22 AN crew is continuing to grade area and also appears that they are drilling to blast rock
Misc
Informational
09/26/2022
On Monday 9-26-2022. K&B Excavating moving dirt fill and filling areas at various locations throughout project. 01/16/23 Monday JMJ Contractor using small track hoe to re-grade newly constructed Main Street for curb installation.
Retaining Wall Inspection Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/16/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12/23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/16/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/17/23 Tuesday JMJ ( BC Hardscape) Olson 3rd Party Inspection Continued to install retaining wall see pictures and videos of construction.
Public Curb Inspection Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Freedom Construction ) The contractor is string line and continuing grading for curb pour.
Storm Sewer Construction Inspection Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/16/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/16/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/16/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/16/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/16/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 .
Erosion Control Inspection Partial 1/18/2023 1/18/2023 01/18/2023
Misc
Informational
07/14/2022
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
07/14/2022
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
07/14/2022
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
07/14/2022
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Pavement-Surface Partial 1/17/2023 1/17/2023 01/20/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Sideworks Construction ) Contractor continued to compact, roll, and grade streets throughout the week.
Retaining Wall Inspection Partial 1/23/2023 1/23/2023 01/23/2023
Misc
Informational
01/17/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12/23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/16/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/17/23 Tuesday JMJ ( BC Hardscape ) Olson 3rd Party Inspection Continued to install retaining wall see pictures and videos of construction. 01/23/23 Monday JMJ ( BC Hardscape ) Contractor continued to install retaining wall.
Storm Sewer Construction Inspection Partial 1/24/2023 1/24/2023 01/24/2023
Misc
Informational
01/17/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/17/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/17/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/17/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/17/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4.
Erosion Control Inspection Partial 1/26/2023 1/26/2023 01/26/2023
Misc
Informational
01/18/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
01/18/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
01/18/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
01/18/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
01/26/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Retaining Wall Inspection Partial 1/27/2023 1/27/2023 01/27/2023
Misc
Informational
01/23/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12/23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/16/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/17/23 Tuesday JMJ ( BC Hardscape ) Olson 3rd Party Inspection Continued to install retaining wall see pictures and videos of construction. 01/23/23 Monday JMJ ( BC Hardscape ) Contractor continued to install retaining wall. 01/27/23 Friday JMJ ( BC Hardscape ) Contractor has not worked on the retaining wall for a few days because of the inclement weather.
Erosion Control Inspection Partial 2/14/2023 2/14/2023 02/14/2023
Misc
Informational
01/26/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
01/26/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
01/26/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
01/26/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
01/26/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
01/26/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
02/14/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Site Visit Partial 2/21/2023 2/21/2023 02/21/2023
Misc
Informational
12/21/2022
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall. 12/21/22 Wednesday JMJ ( BC Hardscape Landscape Construction ) Continued installation of foundation for retaining wall. 02/21/23 Tuesday JMJ ( Central Plumbing Co. Steve & Brain Crews ) Contractor focused on breaking rock detention areas on the West and Eastside of Future Main Street. Rock ( Rip-Rap ) was placed at the the exit and of the 12'X12' RCP storm drain.
Retaining Wall Inspection Partial 3/2/2023 3/2/2023 03/02/2023
Misc
Informational
01/27/2023
12/29/22 Thursday JMJ ( BC Hardscape ) It appears that contractor is beginning the process of setting the foundation blocks of retaining wall. ( To view the records and notes for Retaining Wall see Site Visit portion of permit ). 12/30/22 Friday JMJ ( BC Hardscape ) Contractor appeared to doing some light work and more modular brick were delivered for retaining wall. 01/03/23 Tuesday JMJ ( BC Hardscape ) Contractor appeared to be doing some work, I will verify work done later this week due to site conditions cause by the inclement weather from last night. 01/05/23 Thursday JMJ ( BC Hardscape ) Continued to set and lay foundation bricks for retaining wall. 01/06/23 Friday JMJ ( BC Hardscape ) Continued to set and lay retaining wall. 01/09/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/10/23 Tuesday JMJ ( BC Hardscape ) Continued to install retaining wall with Geogrid covered with gravel rock. Third party inspector and surveyor was onsite to observe the construction of retaining wall ( Olsson ). 01/11/23 Wednesday JMJ ( BC Hardscape ) Continue the construction of retaining wall. 01/12/23 Friday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/16/23 Monday JMJ ( BC Hardscape ) Continued to install retaining wall. 01/17/23 Tuesday JMJ ( BC Hardscape ) Olson 3rd Party Inspection Continued to install retaining wall see pictures and videos of construction. 01/23/23 Monday JMJ ( BC Hardscape ) Contractor continued to install retaining wall. 01/27/23 Friday JMJ ( BC Hardscape ) Contractor has not worked on the retaining wall for a few days because of the inclement weather.
Misc
Informational
03/02/2023
03/02/23 Thursday JMJ ( BC Hardscape ) Contractor restarted construction of retaining wall this week.
Erosion Control Inspection Partial 3/9/2023 3/9/2023 03/13/2023
Misc
Informational
02/14/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
02/14/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
02/14/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
02/14/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
02/14/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
02/14/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
02/14/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
03/13/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets.
Water Line - Construction Inspection Partial 3/13/2023 3/13/2023 03/13/2023
Misc
Informational
06/10/2022
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/13/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/13/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street .
Storm Sewer Construction Inspection Partial 3/14/2023 3/14/2023 03/14/2023
Misc
Informational
01/30/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/30/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/30/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/30/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/30/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4. 01/30/23 Monday JMJ ( Central Plumbing-Steve ) Contractor backfilled installed storm structure. 03/14/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed connector on Line A to Line B yesterday 42" RCP approximately 22.5' to curb inlet B1. Contractor installed curb inlet B2 today around 9:00 AM and working on the 42" RCP pipe installation between B1 to B2 curb inlet structure, as-per project plans 93.5 LF of 42.
Erosion Control Inspection Partial 3/16/2023 3/16/2023 03/24/2023
Misc
Informational
03/13/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
03/13/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
03/13/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
03/13/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
03/13/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
03/13/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
03/13/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
03/13/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Water Line - Construction Inspection Partial 3/28/2023 3/28/2023 03/28/2023
Misc
Informational
03/13/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/13/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/13/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection.
Water Line - Construction Inspection Partial 03/28/2023
Misc
Informational
03/28/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/28/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/28/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23.
Water Line - Construction Inspection Partial 3/29/2023 3/29/2023 03/29/2023
Misc
Informational
03/28/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/28/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/28/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics.
Water Line - Construction Inspection Partial 3/30/2023 3/30/2023 03/30/2023
Misc
Informational
03/29/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/29/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/29/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street.
Water Line - Construction Inspection Partial 3/31/2023 3/31/2023 03/31/2023
Misc
Informational
03/30/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/30/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/30/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street.
Site Visit Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
02/21/2023
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall. 12/21/22 Wednesday JMJ ( BC Hardscape Landscape Construction ) Continued installation of foundation for retaining wall. 02/21/23 Tuesday JMJ ( Central Plumbing Co. Steve & Brain Crews ) Contractor focused on breaking rock detention areas on the West and Eastside of Future Main Street. Rock ( Rip-Rap ) was placed at the the exit and of the 12'X12' RCP storm drain. 04/03/23 Monday JMJ ( Central Plumbing Co. - Steve ) Contractor perform miscellaneous work on site.
Erosion Control Inspection Partial 4/20/2023 4/20/2023 04/20/2023
Misc
Informational
03/24/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
03/24/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
03/24/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
03/24/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
03/24/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
03/24/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
03/24/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
03/24/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
04/20/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Erosion Control Inspection Partial 5/16/2023 5/16/2023 05/16/2023
Misc
Informational
04/20/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
04/20/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
04/20/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
04/20/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
04/20/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
04/20/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
04/20/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
04/20/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
04/20/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Misc
Informational
05/16/2023
05/16/23 JMJ ( Kadean - Ryan ) Contractor had to clean mud and slit from Northern borders NE Tudor Rd & Southern borders NE Victoria Drive. Vehicles coming from site dragged mud and slit onto street.
Water Line - Construction Inspection Partial 5/17/2023 5/17/2023 05/17/2023
Misc
Informational
03/31/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
03/31/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
03/31/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware.
Miscellaneous PWORKS Inspection Partial 5/17/2023 5/17/2023 05/17/2023
Misc
Informational
05/17/2023
05/17/23 Wednesday JMJ ( Kadean ) Contractor began demo of NW Sloan Street for installation of utilities and reconstruction of street. Work started last week.
Miscellaneous PWORKS Inspection Partial 5/18/2023 5/18/2023 05/18/2023
Misc
Informational
05/18/2023
05/18/23 Thursday JMJ ( Kadean ) Contractor has been in the the process of demo NW Commerce Drive last week. The road has been permitted and close for the duration of reasonable construction time.
Storm Sewer Construction Inspection Partial 5/24/2023 5/24/2023 05/24/2023
Misc
Informational
03/14/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
03/14/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
03/14/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
03/14/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
03/14/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4. 01/30/23 Monday JMJ ( Central Plumbing-Steve ) Contractor backfilled installed storm structure. 03/14/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed connector on Line A to Line B yesterday 42" RCP approximately 22.5' to curb inlet B1. Contractor installed curb inlet B2 today around 9:00 AM and working on the 42" RCP pipe installation between B1 to B2 curb inlet structure, as-per project plans 93.5 LF of 42.
Misc
Informational
05/24/2023
05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installing storm box 12 along Commerce Drive & Main Street. Changes may have to be made do to conflict with existing gas grading elevation.
Water Line - Construction Inspection Partial 5/24/2023 5/24/2023 05/24/2023
Misc
Informational
05/17/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/17/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/17/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins.
Water Line - Construction Inspection Partial 05/24/2023
Misc
Informational
05/24/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/24/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/24/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8".
Water Line - Construction Inspection Partial 5/25/2023 5/25/2023 05/25/2023
Misc
Informational
05/24/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/24/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/24/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday.
Water Line - Construction Inspection Partial 05/26/2023
Misc
Informational
05/25/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/25/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/25/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday. 05/26/23 Friday JMJ ( Central Plumbing - Steve ) Contractor installed 2-12" valves and 12" gate valve on tie-in . Inspector can not allow contractor to tie-in 8" because the newly installed line would be connecting at all point to existing lines.
Water Line - Construction Inspection Partial 5/30/2023 5/30/2023 05/30/2023
Misc
Informational
05/26/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/26/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/26/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday. 05/26/23 Friday JMJ ( Central Plumbing - Steve ) Contractor installed 2-12" valves and 12" gate valve on tie-in . Inspector can not allow contractor to tie-in 8" because the newly installed line would be connecting at all point to existing lines. 05/30/23 Tuesday JMJ ( Central Plumbing - Steve ) Contractor set lids on storm boxes along NW Commerce Road & Main Street. Contractor dug up 12" water main for construction tap.
Erosion Control Inspection Partial 6/1/2023 6/1/2023 06/01/2023
Misc
Informational
05/16/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
05/16/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
05/16/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
05/16/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
05/16/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
05/16/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
05/16/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
05/16/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
05/16/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Misc
Informational
05/16/2023
05/16/23 JMJ ( Kadean - Ryan ) Contractor had to clean mud and slit from Northern borders NE Tudor Rd & Southern borders NE Victoria Drive. Vehicles coming from site dragged mud and slit onto street.
Misc
Informational
06/01/2023
06/01/23 JMJ ( Kadean - Ryan ) Contractor had to clean up excessive mud off adjacent streets that was track by vehicle traffic. Erosion control measure or still in place and functioning.
Water Line - Construction Inspection Partial 6/1/2023 6/1/2023 06/01/2023
Misc
Informational
05/30/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
05/30/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
05/30/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday. 05/26/23 Friday JMJ ( Central Plumbing - Steve ) Contractor installed 2-12" valves and 12" gate valve on tie-in . Inspector can not allow contractor to tie-in 8" because the newly installed line would be connecting at all point to existing lines. 05/30/23 Tuesday JMJ ( Central Plumbing - Steve ) Contractor set lids on storm boxes along NW Commerce Road & Main Street. Contractor dug up 12" water main for construction tap. 06/01/23 Thursday ( Central Plumbing - Steve ) Contractor shored up Northern location of were tap for 12" water main clean up area of taps and blow-off. Contractor preparing 8" & 12" water main for pressure test.
Water Line - Construction Inspection Partial 6/2/2023 6/2/2023 06/02/2023
Misc
Informational
06/01/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
06/01/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
06/01/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday. 05/26/23 Friday JMJ ( Central Plumbing - Steve ) Contractor installed 2-12" valves and 12" gate valve on tie-in . Inspector can not allow contractor to tie-in 8" because the newly installed line would be connecting at all point to existing lines. 05/30/23 Tuesday JMJ ( Central Plumbing - Steve ) Contractor set lids on storm boxes along NW Commerce Road & Main Street. Contractor dug up 12" water main for construction tap. 06/01/23 Thursday ( Central Plumbing - Steve ) Contractor shored up Northern location of were tap for 12" water main clean up area of taps and blow-off. Contractor preparing 8" & 12" water main for pressure test. 06/02/23 Friday ( Central Plumbing - Steve ) Contractor is trying to isolate issue on 12" main from the existing an the old main. Contractor has decided to install 12" valve that will separate newly installed main, so hydro static test can be performed.
Water Line - Hydrostatic Test Passed 6/5/2023 6/5/2023 06/05/2023
Misc
Informational
06/05/2023
06/05/23 Monday JMJ ( Central Plumbing - Steve ) Contractor passed hydrostatic test @ 150 psi for two hour staring at 12:00PM.
Water Line - Construction Inspection Partial 6/6/2023 6/6/2023 06/06/2023
Misc
Informational
06/06/2023
06/06/23 Tuesday JMJ ( Central Plumbing ) Contractor chlorinated 8" and all 12" PVC public water main as per plan approximately 3,500 feet of water pipe. Time of chlorination 4:00PM.
Pavement-Stabilized Subgrade Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/07/2023
06/07/23 Wednesday JMJ Contractor continue to stabilize road by installing rock material rolling it for compaction, along main street towards Victoria Drive.
Water Line - Construction Inspection Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/02/2023
06/10/22 Friday (Central Plumbing) Contractor excavation existing line for abandonment on NW Main Street.
Misc
Informational
06/02/2023
07/22/22 Friday JMJ ( Central Plumbing/Steve ) Contractor will install approximately 300’ of 12” PVC serta lock pipe from 12+90 to 15+90 for public water main. As-built will reflect changes in installation of 11.25 deg bends. 7-26-22 AN. Spoke with Steve from central plumbing. Water main and all T,s have no valves on the plans . Central plumbing is going to call their engineers to revise the plans. 08/10/22 Wednesday JMJ ( Central Plumbing/Steve ) Contractor return to work site today valves were on 12” main ever 500’ . The contractor was able to locate the newly install water main pipe. 12” gate valve, 12”x12”x10” tee, and 12”x12”x4” tee & 4” gate valve was installed. Contractor installed approximately 40’ of water pipe. 08/11/22 Thursday JMJ ( Central Plumbing/Steve ) The contractor has continued to install 12” water main from Sta. 19+70 approximately. Contractor has install more than 200’ of 12” PVC water main @ 9:40AM. Fire Hydrant is at Sta. 21+95.67. Two 12” valves and a 12”x8” tee was installed but the Sta. were not identified on the plans. 08/15/22 Monday JMJ ( Central Plumbing/Steve ) Contractor installing on 12” water main that were missed by Contractor’s Engineer. Contractor backfilled excavation of line from today and last week. Contractor of load materials that were delivered to site. 08/23/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor installed one stick pipe of 8” pipe on the fire line. Contractor poured backing blocks on newly installed 12” pipe. 09/13/22 Tuesday JMJ ( Central Plumbing/ Steve ) Contractor restarted installation of 8” PVC Private Fire Line approximately 280’ on the North side of proposed building. Starting at the fire hydrant going West on the Northside ( No Station are on plans ). 100’ was installed going West for a total of approximately 380’ of Fire line . All excavation was backfilled. 09/14/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor installed 4”domestic 8” & 10” Fire Line that runs to the building as-per plan pg. C 6.02. 09/16/22 Friday JMJ ( Central PLumbing/ Steve ) Contractor continued installation of 8” Fire Line Approximately 300’ along the Eastside @ 10:35Am. Yesterday Approximately 140’ of 4” domestic & 10” Fire Line was installed @ the Northeast corner of proposed building. Contractor installed 120’ of 8 “ Fire Line going South on the Eastside of building. Contractor end the day with approximately 400’ of 8” Fire Line. 9/19/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued to install 8” Fire Line on or near the Southwest corner of building. Fire Hydrant was also installed off that 8” Fire Line as-per plan. Contractor installed Backflow Preventer vault for 10” Fire Line & 8” vault that was not on project plans. 10/06/22 Thursday JMJ ( Central Plumbing/ Steve ) Contractor restarted installing 8” Fire Line on The Southwest corner of building turned going West. Approximately 300’ of 8” Fire Line. 10/10/22 Monday JMJ ( Central Plumbing/ Steve ) Contractor continued installation of 8” Fire line as-per project plans. 10/13/22 Thursday JMJ ( Central Plumbing ) The installed on the South & Eastern side of building also breaking rocky to complete water line. 01/16/23 Monday JMJ ( Central Plumbing - Steve ) Contractor plans to install 8” Fire line as-per plan on the Northwest side of building .
Misc
Informational
06/02/2023
03/13/23 Monday JMJ ( Central Plumbing- Steve ) Restarted installation of the public water main along proposed Main Street . 03/28/23 Tuesday JMJ Central Plumbing - Steve ) Contractor exposed existing 12" water line so they can tie-in. Contractor will need to dig existing pipe near existing valve to chlorinate approximately 300' of 12" existing water line that has been off and newly installed main. The city will tap line at a later date when contractor is ready for disinfection. Contractor installed approximately 380' of 12" water line and hydrant 03/27/23 and approximately, approximately 300' of 12" water line and hydrant 03/28/23. 03/29/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor connected to existing to 12" water main on North end of project N. Main St. & NW Victoria St. 2/ 45 deg bends and approximately 40' of 12" PVC pipe . 45 deg bend is connected to the existing 12" main and the newly installed 12" PVC water main. See today pics. 03/30/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor poured thrust blocks behind 45 deg bends and hydrant that was installed. Contractor continue to install 12" water line approximately 80, South of building 2. Contract installed 2/ 12"x4" tees & 12"x10" tee today. Contractor plans to install 2/ 4" line & 10" water line going East across proposed Main Street. 03/31/23 Friday JMJ ( Central Plumbing - Steve ) Contractor continued to install 4" lines across proposed street. 05/17/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installed approximately 500' of 12" public water main between Bld #1 and Bld #2. Contractor had to install 2/ 45 Deg bends 65' South of storm box that is South of Bld #2 to avoid utilities staying with in the easement. Note: contractor was working in the inclement weather yesterday, but the inspector was not aware. 05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor planning the construction of 8" line and tie-ins on 8" & 12" . Requested direction for installation of water main across existing storm line. Inspector has identified valves required for water shuts for tie-ins. Installing 8" water along Commerce Drive as-per contractor was able to go under storm pipe approximately 21". Contractor installed approximately 300' of 8". 05/25/23 Thursday JMJ (Central Plumbing - Steve ) Contractor installed approximately 300' of 8" PVC water main. Contractor found a blow-off valve @ the end of existing 8" water main on Commerce Drive & NW Sloan Street. Contractor prepared for tie-in with 12"X12" & 12" gate valve at the intersection of Commerce Road & NW Main St., and tie-in on 8" blow-off valve converted to inline valve. Tie-in will occur tomorrow starting @ 8:00AM 05/26/23 Friday. 05/26/23 Friday JMJ ( Central Plumbing - Steve ) Contractor installed 2-12" valves and 12" gate valve on tie-in . Inspector can not allow contractor to tie-in 8" because the newly installed line would be connecting at all point to existing lines. 05/30/23 Tuesday JMJ ( Central Plumbing - Steve ) Contractor set lids on storm boxes along NW Commerce Road & Main Street. Contractor dug up 12" water main for construction tap. 06/01/23 Thursday JMJ ( Central Plumbing - Steve ) Contractor shored up Northern location of were tap for 12" water main clean up area of taps and blow-off. Contractor preparing 8" & 12" water main for pressure test. 06/02/23 Friday JMJ ( Central Plumbing - Steve ) Contractor is trying to isolate issue on 12" main from the existing an the old main. Contractor has decided to install 12" valve that will separate newly installed main, so hydro static test can be performed. 06/07/23 Wednesday JMJ (Central Plumbing-Steve) Due possible City View error chlorination report from 06/06/23 is on another permit. Contractor will de-chlorinate 8" and 12" public water main starting at 4:00PM today.
Water Line - Coliform Test 1 Passed 6/8/2023 6/8/2023 06/09/2023
Misc
Informational
06/09/2023
All three of the first bacteria samples passed on installed water. See Key Stone documents.
Water Line - Coliform Test 2 Passed 6/13/2023 6/13/2023 06/13/2023
Misc
Informational
06/13/2023
06/13/23 Tuesday JMJ (Central Plumbing) Bacteria samples collected on 06/09/23 passed.
Water Line - Construction Inspection Passed 6/13/2023 6/13/2023 06/13/2023
Misc
Informational
06/13/2023
06/13/23 Tuesday JMJ (Central Plumbing) Alert the Water Department that bacteria samples passed.
Storm Sewer Construction Inspection Partial 6/16/2023 6/16/2023 06/16/2023
Misc
Informational
05/24/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
05/24/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
05/24/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
05/24/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
05/24/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4. 01/30/23 Monday JMJ ( Central Plumbing-Steve ) Contractor backfilled installed storm structure. 03/14/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed connector on Line A to Line B yesterday 42" RCP approximately 22.5' to curb inlet B1. Contractor installed curb inlet B2 today around 9:00 AM and working on the 42" RCP pipe installation between B1 to B2 curb inlet structure, as-per project plans 93.5 LF of 42.
Misc
Informational
05/24/2023
05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installing storm box 12 along Commerce Drive & Main Street. Changes may have to be made do to conflict with existing gas grading elevation. 06/16/23 Friday JMJ ( Central Plumbing - Steve ) Contractor spent yesterday adjusting storm boxes to the proper level for the proposed street. Contractor has installed all public storm boxes as-per project plans.
Pavement-Proof Roll Partial 6/27/2023 6/27/2023 06/27/2023
Misc
Informational
06/27/2023
06/27/23 Tuesday Proof roll passed. Olsson was the third party tester.
Pavement-Aggregate Base Partial 6/29/2023 6/29/2023 06/29/2023
Misc
Informational
06/29/2023
06/29/23 Thursday JMJ ( Thorne & Son Asphalt, Freedom Concrete ) Contractor began to lay type 5 recycled asphalt on public street (NE Main Street) . Contractor began working around 6:15AM inspector was not informed of the start time. Contractor installing a 3" to 4" first base lift for the entire length of public street. Third party testing Olsson is taking all the required test and samples so, far all density reading have been passing. Freedom is grading asphalt for curbs and storm throat to be installed after the first base lift is completed.
Pavement-Aggregate Base Partial 6/30/2023 6/30/2023 07/01/2023
Misc
Informational
06/29/2023
06/29/23 Thursday JMJ ( Thorne & Son Asphalt, Freedom Concrete ) Contractor began to lay type 5 recycled asphalt on public street (NE Main Street) . Contractor began working around 6:15AM inspector was not informed of the start time. Contractor installing a 3" to 4" first base lift for the entire length of public street. Third party testing Olsson is taking all the required test and samples so, far all density reading have been passing. Freedom is grading asphalt for curbs and storm throat to be installed after the first base lift is completed. 06/30/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor completed that passes of laying the first base asphalt layer on NE Main Street and connecting streets. The asphalt tickets were collected 61 loads yesterday @ 1918.89 total tons, 24 loads today @ 725.86 tons.
Public Curb Inspection Partial 7/5/2023 7/5/2023 07/06/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Freedom Construction ) The contractor is string line and continuing grading for curb pour. 07/06/23 Wednesday JMJ ( Freedom Construction ) Freedom concrete started to pour curbs on NW Main Street & NW Sloan Street yesterday and continued today.
Driveway Inspection Partial 7/11/2023 7/11/2023 07/11/2023
Misc
Informational
07/11/2023
07/11/23 Tuesday JMJ (Fenix Construction) Contractor grade materials and constructed forms on 07/10/23. The first approach was poured on Main Street & NE Tudor RD. Inspector witness contractor putting clear cure on first approach. Inspector informed General Contractor Kadean that the cure should be white.
Driveway Inspection Partial 7/12/2023 7/12/2023 07/12/2023
Misc
Informational
07/11/2023
07/11/23 Tuesday JMJ (Fenix Construction) Contractor grade materials and constructed forms on 07/10/23. The first approach was poured on Main Street & NE Tudor RD. Inspector witness contractor putting clear cure on first approach. Inspector informed General Contractor Kadean that the cure should be white. 07/12/23 Wednesday JMJ (Fenix Construction) contractor continued to grade & place materials on approaches on Main Street. The second approach is located @ the NE side of building #1. Contractor plans to pour concrete tomorrow.
Pavement-Surface Partial 7/28/2023 7/28/2023 07/28/2023
Misc
Informational
01/20/2023
01/17/23 Tuesday JMJ ( Sideworks Construction ) Contractor continued to compact, roll, and grade streets throughout the week.
Misc
Informational
07/28/2023
07/28/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor laid first surface layer APWATYPIAPWA type 5 recycle on Main Street & NW Sloan Street.
Misc
Informational
09/25/2023
09/25/23 Monday (Thorne & Son Asphalt) Contractor began to lay surface asphalt 09/23/23 on NW Main St & NW Sloan St on along building #1. Contractor had to stop asphalt pavement after 11:00 AM. Contractor continued to lay asphalt @ 7:30 AM today on NW Main St APWA type 5-01.
Pavement-Aggregate Base Partial 7/28/2023 7/28/2023 07/28/2023
Misc
Informational
07/01/2023
06/29/23 Thursday JMJ ( Thorne & Son Asphalt, Freedom Concrete ) Contractor began to lay type 5 recycled asphalt on public street (NE Main Street) . Contractor began working around 6:15AM inspector was not informed of the start time. Contractor installing a 3" to 4" first base lift for the entire length of public street. Third party testing Olsson is taking all the required test and samples so, far all density reading have been passing. Freedom is grading asphalt for curbs and storm throat to be installed after the first base lift is completed. 06/30/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor completed that passes of laying the first base asphalt layer on NE Main Street and connecting streets. The asphalt tickets were collected 61 loads yesterday @ 1918.89 total tons, 24 loads today @ 725.86 tons. 07/28/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor installed approximately 1503 tons of second layer of base asphalt type 5 recycled NW Main Street & NW Sloan Street.
Sidewalk Inspection Partial 8/15/2023 8/15/2023 08/15/2023
Misc
Informational
08/15/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street.
Sidewalk Inspection Partial 8/16/2023 8/16/2023 08/16/2023
Misc
Informational
08/15/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also.
Pavement-Aggregate Base Partial 8/16/2023 8/16/2023 08/16/2023
Misc
Informational
07/28/2023
06/29/23 Thursday JMJ ( Thorne & Son Asphalt, Freedom Concrete ) Contractor began to lay type 5 recycled asphalt on public street (NE Main Street) . Contractor began working around 6:15AM inspector was not informed of the start time. Contractor installing a 3" to 4" first base lift for the entire length of public street. Third party testing Olsson is taking all the required test and samples so, far all density reading have been passing. Freedom is grading asphalt for curbs and storm throat to be installed after the first base lift is completed. 06/30/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor completed that passes of laying the first base asphalt layer on NE Main Street and connecting streets. The asphalt tickets were collected 61 loads yesterday @ 1918.89 total tons, 24 loads today @ 725.86 tons. 07/28/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor installed approximately 1503 tons of second layer of base asphalt type 5 recycled NW Main Street & NW Sloan Street. 08/16/23 Wednesday JMJ ( Thorne & Son Asphalt ) Contractor finishing the base asphalting going North on Main Street. Contractor applied tack before laying type 5 recycled asphalt.
Sidewalk Inspection Partial 8/17/2023 8/17/2023 08/17/2023
Misc
Informational
08/16/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest.
Sidewalk Inspection Partial 8/18/2023 8/18/2023 08/18/2023
Misc
Informational
08/17/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. 08/18/23 Friday JMJ ( Freedom Concrete ) Contractor is on pouring sidewalks the Southside of Main Street moving Northeast along building #1.
Sidewalk Inspection Partial 8/21/2023 8/21/2023 08/21/2023
Misc
Informational
08/18/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. 08/18/23 Friday JMJ ( Freedom Concrete ) Contractor is on pouring sidewalks the Southside of Main Street moving Northeast along building #1. 08/21/23 Monday JMJ ( Freedom Concrete ) Contractor continued to construct sidewalks on the Westside of Main Street heading North toward NW Victoria Drive.
Site Visit Partial 9/15/2023 9/15/2023 09/15/2023
Misc
Informational
04/03/2023
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall. 12/21/22 Wednesday JMJ ( BC Hardscape Landscape Construction ) Continued installation of foundation for retaining wall. 02/21/23 Tuesday JMJ ( Central Plumbing Co. Steve & Brain Crews ) Contractor focused on breaking rock detention areas on the West and Eastside of Future Main Street. Rock ( Rip-Rap ) was placed at the the exit and of the 12'X12' RCP storm drain. 04/03/23 Monday JMJ ( Central Plumbing Co. - Steve ) Contractor perform miscellaneous work on site. 09/15/23 Friday JMJ ( Central Plumbing-Steve ) Contractor worked throughout the week to complete storm, water, and sanitary on project.
Sidewalk Inspection Partial 9/28/2023 9/28/2023 09/28/2023
Misc
Informational
08/21/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. 08/18/23 Friday JMJ ( Freedom Concrete ) Contractor is on pouring sidewalks the Southside of Main Street moving Northeast along building #1. 08/21/23 Monday JMJ ( Freedom Concrete ) Contractor continued to construct sidewalks on the Westside of Main Street heading North toward NW Victoria Drive. 09/28/23 Thursday JMJ ( Freedom Concrete ) Contractor continued pouring sidewalks along NW Main Street.
Sidewalk Inspection Partial 10/5/2023 10/5/2023 10/05/2023
Misc
Informational
09/28/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. 08/18/23 Friday JMJ ( Freedom Concrete ) Contractor is on pouring sidewalks the Southside of Main Street moving Northeast along building #1. 08/21/23 Monday JMJ ( Freedom Concrete ) Contractor continued to construct sidewalks on the Westside of Main Street heading North toward NW Victoria Drive. 09/28/23 Thursday JMJ ( Freedom Concrete ) Contractor continued pouring sidewalks along NW Main Street. 10/05/23 Thursday JMJ ( Freedom Concrete ) .Contractor continued to pour sidewalks section that were not installed due to utilities that needed to be relocated. Contractor also poured area on NW Main Street long stretch North of NE Tudor Road yesterday. Inspector will continue to monitor progress of concrete pours.
Pavement-Surface Partial 10/19/2023 10/19/2023 10/19/2023
Misc
Informational
07/28/2023
01/17/23 Tuesday JMJ ( Sideworks Construction ) Contractor continued to compact, roll, and grade streets throughout the week.
Misc
Informational
07/28/2023
07/28/23 Friday JMJ ( Thorne & Son Asphalt ) Contractor laid first surface layer APWATYPIAPWA type 5 recycle on Main Street & NW Sloan Street. 10/19/23 Thursday JMJ ( Thorne & Son Asphalt ) Contractor completed Main Street.
Erosion Control Inspection Partial 10/27/2023 10/27/2023 10/27/2023
Misc
Informational
06/01/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
06/01/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
06/01/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
06/01/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
06/01/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
06/01/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
06/01/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
06/01/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
06/01/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Misc
Informational
06/01/2023
05/16/23 JMJ ( Kadean - Ryan ) Contractor had to clean mud and slit from Northern borders NE Tudor Rd & Southern borders NE Victoria Drive. Vehicles coming from site dragged mud and slit onto street.
Misc
Informational
06/01/2023
06/01/23 JMJ ( Kadean - Ryan ) Contractor had to clean up excessive mud off adjacent streets that was track by vehicle traffic. Erosion control measure or still in place and functioning. 10/27/23 JMJ ( Kadean- Ryan ) Contractor will be place silt fence @ all areas that have silt overruns due to excessive rains. Contractor will clean-up silt areas.
Site Visit Partial 11/7/2023 11/7/2023 11/07/2023
Misc
Informational
09/15/2023
04/05/22 Tuesday B&H Construction The contractor called to inform me that they had snagged an Overhead Line. Preliminary investigation leans towards it being a communication line. Contractor called the City of Lee’s Summit and a City Right-A-Way agent came out for investigation. Right-A-Way inspector will continue research to find out what utilities company the expansion line belongs to inform them of the incident at NW Main Street & NW Tudor Road. 12/08/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been installing Geogrid, tarp material and gravel for the foundation of the Retaining Wall. 12/09/22 Friday JMJ ( BC Hardscape Landscape Construction ) Contractor was continuing installation of gravel and support materials for foundation and construction of the Retaining Wall. 12/15/22 Thursday JMJ ( BC Hardscape Landscape Construction ) Contractor has been working on the installation of the third level of supporting foundation since Wednesday. Contractor stated that they were 100% complete the third level of foundation and will begin to form w retaining wall. 12/20/22 Tuesday JMJ ( BC Hardscape Landscape Construction ) Contractor continued to installed foundation for retaining wall. 12/21/22 Wednesday JMJ ( BC Hardscape Landscape Construction ) Continued installation of foundation for retaining wall. 02/21/23 Tuesday JMJ ( Central Plumbing Co. Steve & Brain Crews ) Contractor focused on breaking rock detention areas on the West and Eastside of Future Main Street. Rock ( Rip-Rap ) was placed at the the exit and of the 12'X12' RCP storm drain. 04/03/23 Monday JMJ ( Central Plumbing Co. - Steve ) Contractor perform miscellaneous work on site. 09/15/23 Friday JMJ ( Central Plumbing-Steve ) Contractor worked throughout the week to complete storm, water, and sanitary on project.
Misc
Informational
11/07/2023
11/07/23 Tuesday JMJ ( Kadean ) Contractor has been working to relocate gas utilities and pour sidewalks to get a TCO on building #1 and #3. Contractor has striped NW Main Street and NW Sloan Street. Contractor is waiting on the survey or locates to install required signage.
Public Curb Inspection Partial 11/10/2023 11/10/2023 11/10/2023
Misc
Informational
07/06/2023
01/17/23 Tuesday JMJ ( Freedom Construction ) The contractor is string line and continuing grading for curb pour. 07/06/23 Wednesday JMJ ( Freedom Construction ) Freedom concrete started to pour curbs on NW Main Street & NW Sloan Street yesterday and continued today. 11/10/23 Friday JMJ ( Fredom Construction ) Contractor installed new curbs in median on Tudor Rd as-per project plans.
Erosion Control Inspection Partial 11/21/2023 11/21/2023 11/21/2023
Misc
Informational
10/27/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
10/27/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
10/27/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
10/27/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
10/27/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
10/27/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
10/27/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
10/27/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
10/27/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Misc
Informational
10/27/2023
05/16/23 JMJ ( Kadean - Ryan ) Contractor had to clean mud and slit from Northern borders NE Tudor Rd & Southern borders NE Victoria Drive. Vehicles coming from site dragged mud and slit onto street.
Misc
Informational
10/27/2023
06/01/23 JMJ ( Kadean - Ryan ) Contractor had to clean up excessive mud off adjacent streets that was track by vehicle traffic. Erosion control measure or still in place and functioning. 10/27/23 JMJ ( Kadean- Ryan ) Contractor will be place silt fence @ all areas that have silt overruns due to excessive rains. Contractor will clean-up silt areas.
Misc
Informational
11/21/2023
11/21/23 Tuesday Erosion control was operable.
Sidewalk Inspection Partial 12/12/2023 12/12/2023 12/12/2023
Misc
Informational
10/05/2023
08/15/23 Tuesday JMJ ( Freedom Concrete ) Contract has formed and place material to pour side along Main Street. Contractor is pouring sidewalks on the Northside of Main Street. 8/16/23 Wednesday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. Contractor jumped to the Southside heading Southeast because asphalt base is being installed today also. 08/17/23 Thursday JMJ ( Freedom Concrete ) Continued pouring sidewalks on the Northside Main Street heading Northwest. 08/18/23 Friday JMJ ( Freedom Concrete ) Contractor is on pouring sidewalks the Southside of Main Street moving Northeast along building #1. 08/21/23 Monday JMJ ( Freedom Concrete ) Contractor continued to construct sidewalks on the Westside of Main Street heading North toward NW Victoria Drive. 09/28/23 Thursday JMJ ( Freedom Concrete ) Contractor continued pouring sidewalks along NW Main Street. 10/05/23 Thursday JMJ ( Freedom Concrete ) Contractor continued to pour sidewalks section that were not installed due to utilities that needed to be relocated. Contractor also poured area on NW Main Street long stretch North of NE Tudor Road yesterday. Inspector will continue to monitor progress of concrete pours. 12/12/23 Tuesday JMJ ( Freedom Concrete ) Contractor installed approximately 300' sidewalks on NW Main street and at the corner of NE Tudor Road today. (Public sidewalks)
Storm Sewer Construction Inspection Passed 7/10/2023 7/10/2023 01/03/2024
Misc
Informational
06/16/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
06/16/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
06/16/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
06/16/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
06/16/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4. 01/30/23 Monday JMJ ( Central Plumbing-Steve ) Contractor backfilled installed storm structure. 03/14/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed connector on Line A to Line B yesterday 42" RCP approximately 22.5' to curb inlet B1. Contractor installed curb inlet B2 today around 9:00 AM and working on the 42" RCP pipe installation between B1 to B2 curb inlet structure, as-per project plans 93.5 LF of 42.
Misc
Informational
06/16/2023
05/24/23 Wednesday JMJ ( Central Plumbing - Steve ) Contractor installing storm box 12 along Commerce Drive & Main Street. Changes may have to be made do to conflict with existing gas grading elevation. 06/16/23 Friday JMJ ( Central Plumbing - Steve ) Contractor spent yesterday adjusting storm boxes to the proper level for the proposed street. Contractor has installed all public storm boxes as-per project plans.
Misc
Informational
01/03/2024
01/03/24 Wednesday JMJ Contractor has completed public storm.
Driveway Inspection Passed 01/03/2024
Misc
Informational
07/12/2023
07/11/23 Tuesday JMJ (Fenix Construction) Contractor grade materials and constructed forms on 07/10/23. The first approach was poured on Main Street & NE Tudor RD. Inspector witness contractor putting clear cure on first approach. Inspector informed General Contractor Kadean that the cure should be white. 07/12/23 Wednesday JMJ (Fenix Construction) contractor continued to grade & place materials on approaches on Main Street. The second approach is located @ the NE side of building #1. Contractor plans to pour concrete tomorrow.
Storm Sewer Construction Inspection Passed 1/30/2023 1/30/2023 01/05/2024
Misc
Informational
01/24/2023
07/06/22 Wednesday ( Central Plumbing ) Contractor installed approximately 80’ of 36” RCP from storm box B-3 to B-4.
Misc
Informational
01/24/2023
7-14-22 RH. 36” RCP Storm B-9 to G-1 approximately 55’ was ran and filled over with aggregate and then fill.
Misc
Informational
01/24/2023
09/01/22 Thursday JMJ ( Central Plumbing ) On 08/29/22 Monday contractor install on (private)storm structure K-1 and 100’ of 36” HDPE corrugated pipe . J-1, 2, & 3 180’ of 18” HDPE corrugated pipe. On 08/30/22 Wednesday roof drain (underground) on Southside of building. 1 Fire line on the Southside 8”. Today we began with the installation (private) storm of structure C-2. 09/02/22 Friday JMJ ( Central Plumbing ) Contract installed 24” corrugated HDPE pipe from C-2 to C-3 yesterday and today as per plan. 09/06/22 Tuesday JMJ ( Central Plumbing ) Contractor installed structure J & K in the detention basin and 20’ of 36” HDPE corrugated pipe. contractor installed approximately 140’ of 30” HDPE from D-2 to D-3 on the private side. Excavation was backfilled on piping and structures.
Misc
Informational
01/24/2023
On Wednesday 9-28-2022, Plumbing contractor worked breaking rock to lay remaining 15” HDPE storm pipe for G line on private side. Contractor has about 40LF left to set junction box.
Misc
Informational
01/24/2023
12/08/22 Thursday JMJ ( Central Plumbing - Steve ) Contractor started the installation of 12’X8’ RCB storm drain yesterday. Approximately 70’ of section storm sewer drain is installed today. Contractor will continue to construct storm sewer drain. Wingwall for the RCB crossing was install on 12/07/22 Wednesday. 12/09/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continued installation of 12’X8’ RCB storm drain see pg 32 of 105. Storm Line B will feed into this main truck. 12/12/22 Monday JMJ ( Central Plumbing-Steve ) ( Olsson - Engineer Luke Moore ) Olsson the third party engineer contractor came on site to diagnose the problems of gaps in the 12’X8’ sections throughout the 20 plus pieces ( 4ft to 5ft section pieces )that were constructed. Olsson as suggested that that the primary contractor Kadean call the manufacturer and have them come onsite to also see the issue gap issues that will cause major infiltration. ( Forterra ) 12/15/22 Thursday JMJ ( Central Plumbing-Steve ) Due to the numbers sections not falling into the acceptable tolerance at the connecting points , the storm line was pulled apart and will be regrade and machine equipment will be used to fasten them together (Tugger/ a come along ). 12/16/22 Friday JMJ ( Central Plumbing - Steve ) Contractor continues to reconstruct 12’X8’ Storm Line with (Tugger) joints 3 and 10 are the only section out of tolerance. I suggest that contractor let Olsson know, so the designer will be aware of the issue. 12/19/22 Monday JMJ ( Central Plumbing-Steve ) ( Kadean Construction ) 12’X8’ Storm line appeared to be reconstructed sometime over the weekend. Talked with contractor about ensuring that Olsson okay the construction of the 12’X8’ Storm Line. Contractor he grouted the gaps on outside on sections out of tolerance. 12/20/22 Tuesday JMJ ( Central Plumbing-Steve ) Forterra ( manufacture of the 12’X8’ storm line )& Olsson ( the design engineer ) inspected the re-constructed storm line and approved the correction. Contractor started 30” HDPE corrugated storm pipe on line B starting for storm box B-2 back to B-1. Approximately 250’ of 30” HDPE corrugated storm pipe will be installed on line B. 12/21/22 Wednesday JMJ ( Central Plumbing-Steve ) Installed approximately 60’ of 30” HDPE corrugated storm pipe on storm line B and began to backfill to prepare for inclement weather conditions starting tonight. 01/09/23 Monday JMJ Contractor backfilling 12’X8’ storm line and continuing work on project. 01/13/23 Friday JMJ ( Central Plumbing-Steve ) Toe Wall for the 12’X8’ storm line was poured last week. Approximately 70’ of 18” RCP and 8’X4’ curb inlet @sta 17+84.02 was installed. 01/16/23 Monday JMJ 12’X8’ storm line wing walls to the Eastside on 01/13/23 Friday. Contractor to construct storm line. Contractor will pour concrete on public and private storm line. Contractor has scheduled concrete to arrive at 1:00PM today also the Toewall for the 12’X8’storm line Eastside is to poured along with other public and private storm structures. 01/17/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor installed A4,A3 & A2 approximately 300’ of 18” RCP storm sewer line from A3 to A2. Collar were poured @A4 & A3 . 01/24/23 Tuesday JMJ ( Central Plumbing-Steve ) Contractor has already installed RCP from A1 to A2 and is working to installed RCP from A3 to A4. 01/30/23 Monday JMJ ( Central Plumbing-Steve ) Contractor backfilled installed storm structure.
Erosion Control Inspection Passed 01/05/2024
Misc
Informational
11/21/2023
03/23/22 Wed (Kadean Construction) Erosion control measure and devices were established at the start of the project and the appear to be functioning correctly.
Misc
Corrective Action Required
11/21/2023
05/05/2022 Thursday (HB Const./ KADEAN) Matt Glikbarg with Lee’s summit Public Works called to inform me that silt fencing was compromised near the train tracks. I talked with Paul Bersbach of KADEAN about the silt fencing issue and the fencing contractor is going to be on site to correct all issues. I toured the site and note several area effected by the inclement weather conditions.
Misc
Informational
11/21/2023
5-12-22 AN the silt fence that i did see looked in good working order
Misc
Informational
11/21/2023
7-14-22 RH. Erosion control and silt fence in place and in working order.
Misc
Informational
11/21/2023
01/18/23 Wednesday JMJ Erosion control inspection passed.
Misc
Informational
11/21/2023
01/26/23 Thursday JMJ ( Kadean ) Erosion control inspection passed.
Misc
Informational
11/21/2023
02/14/23 Tuesday ( Kadean ) Contractor will clean streets adjacent to project when the weather is clearer.
Misc
Informational
11/21/2023
03/09/23 Thursday JMJ Call reported that contractor trucks that are entering and exiting site are leaving mud on adjacent street. I talked with the contractor about the clean up. Clean up is difficult do to the rainy condition. Inspector will continue to monitor the streets. 03/22/23 Thursday JMJ Informed contractor about cleaning adjacent street. Sub-contractor will be at the site today to clear street of mud. Working with contractor to update SWIPP onsite .
Misc
Informational
11/21/2023
04/20/23 Thursday JMJ Erosion control measure are still in place. I will continue to watch adjacent street to insure silt and mud does not accumulate from work vehicles and equipment.
Misc
Informational
11/21/2023
05/16/23 JMJ ( Kadean - Ryan ) Contractor had to clean mud and slit from Northern borders NE Tudor Rd & Southern borders NE Victoria Drive. Vehicles coming from site dragged mud and slit onto street.
Misc
Informational
11/21/2023
06/01/23 JMJ ( Kadean - Ryan ) Contractor had to clean up excessive mud off adjacent streets that was track by vehicle traffic. Erosion control measure or still in place and functioning. 10/27/23 JMJ ( Kadean- Ryan ) Contractor will be place silt fence @ all areas that have silt overruns due to excessive rains. Contractor will clean-up silt areas.
Misc
Informational
11/21/2023
11/21/23 Tuesday Erosion control was operable.
Fire Line Construction Inspection Passed 01/05/2024
Misc
Informational
09/28/2022
07/20/22 Wednesday JMJ ( Central Plumbing/ Steve ) Contractor began the installation of the fire lines. The first part of fire line were installed on the NE side of future building. All thread steel was installed @ the 90 deg bends concrete will be poured sometime this week.
Misc
Informational
09/28/2022
On Wednesday 9-28-2022. Miller Plumbing worked in vault area installing 3” copper line for meter installation. ( Tom Taylor)
Documents & Images
Date Uploaded File Type Document Name
03/07/2022 Receipt Receipt for transaction: 2022-001218
03/09/2022 Approved Plans Lee's Summit Logistics - Mass Grading & ESC Approved 3.9.22
03/09/2022 Letter DE-Permit
03/23/2022 Letter INSPECTION SUMMARY
03/29/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/07/2022 Letter INSPECTION SUMMARY

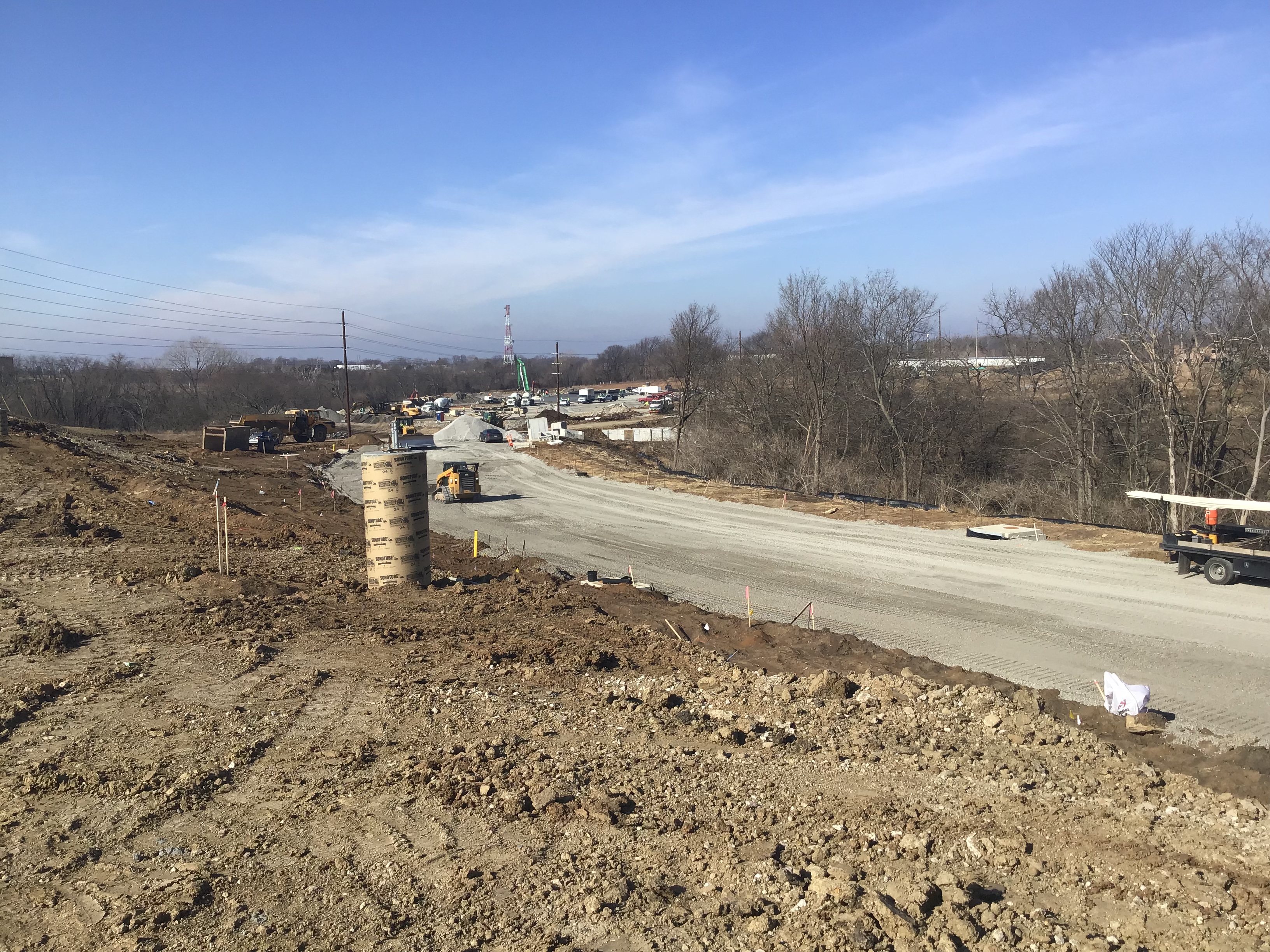

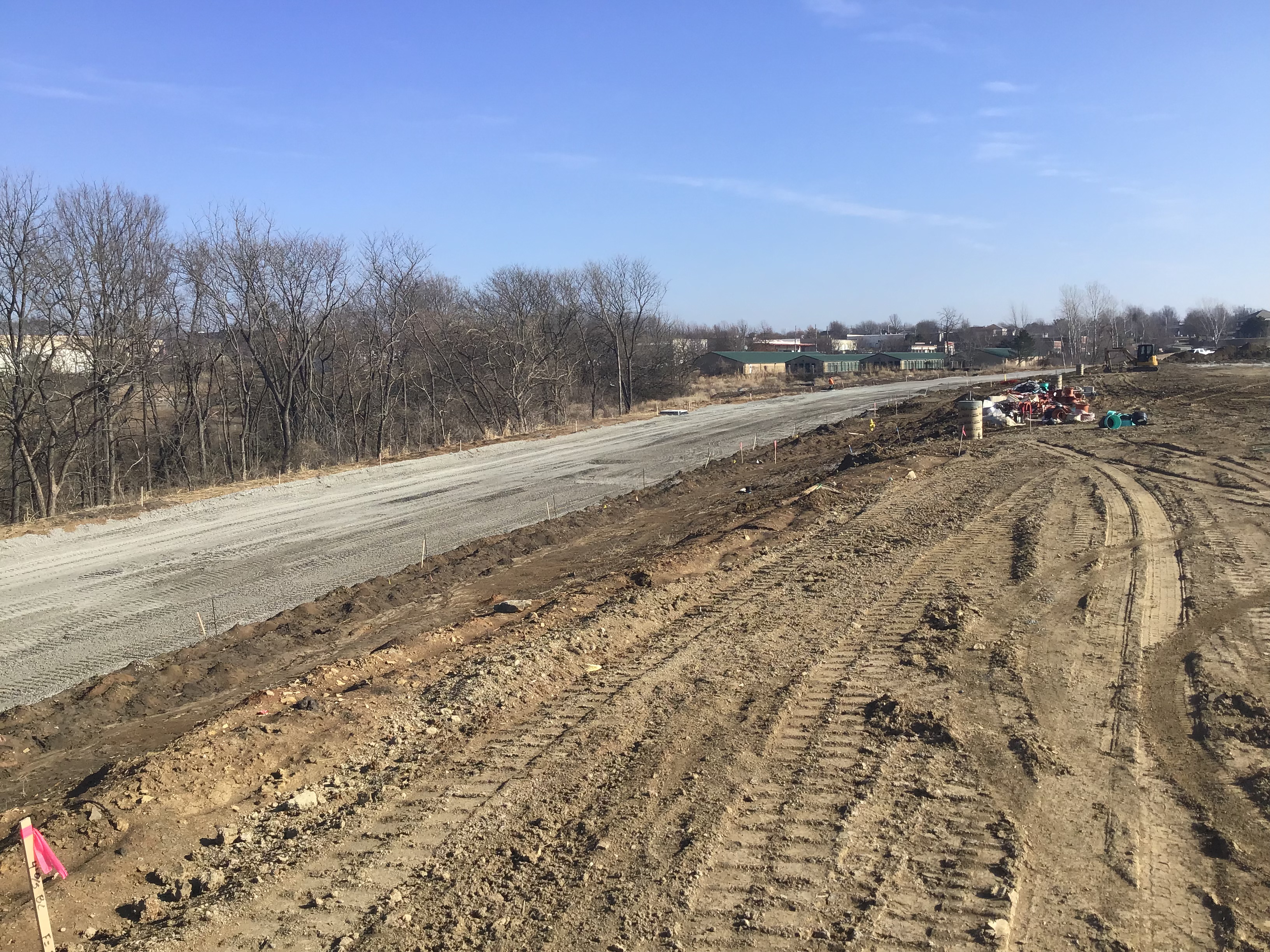

04/12/2022 image
04/12/2022 image0
04/12/2022 image1
04/12/2022 image2
04/12/2022 image3
05/05/2022 Letter INSPECTION SUMMARY
05/06/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/17/2022 Letter INSPECTION SUMMARY
05/18/2022 Letter INSPECTION SUMMARY
05/20/2022 Letter INSPECTION SUMMARY

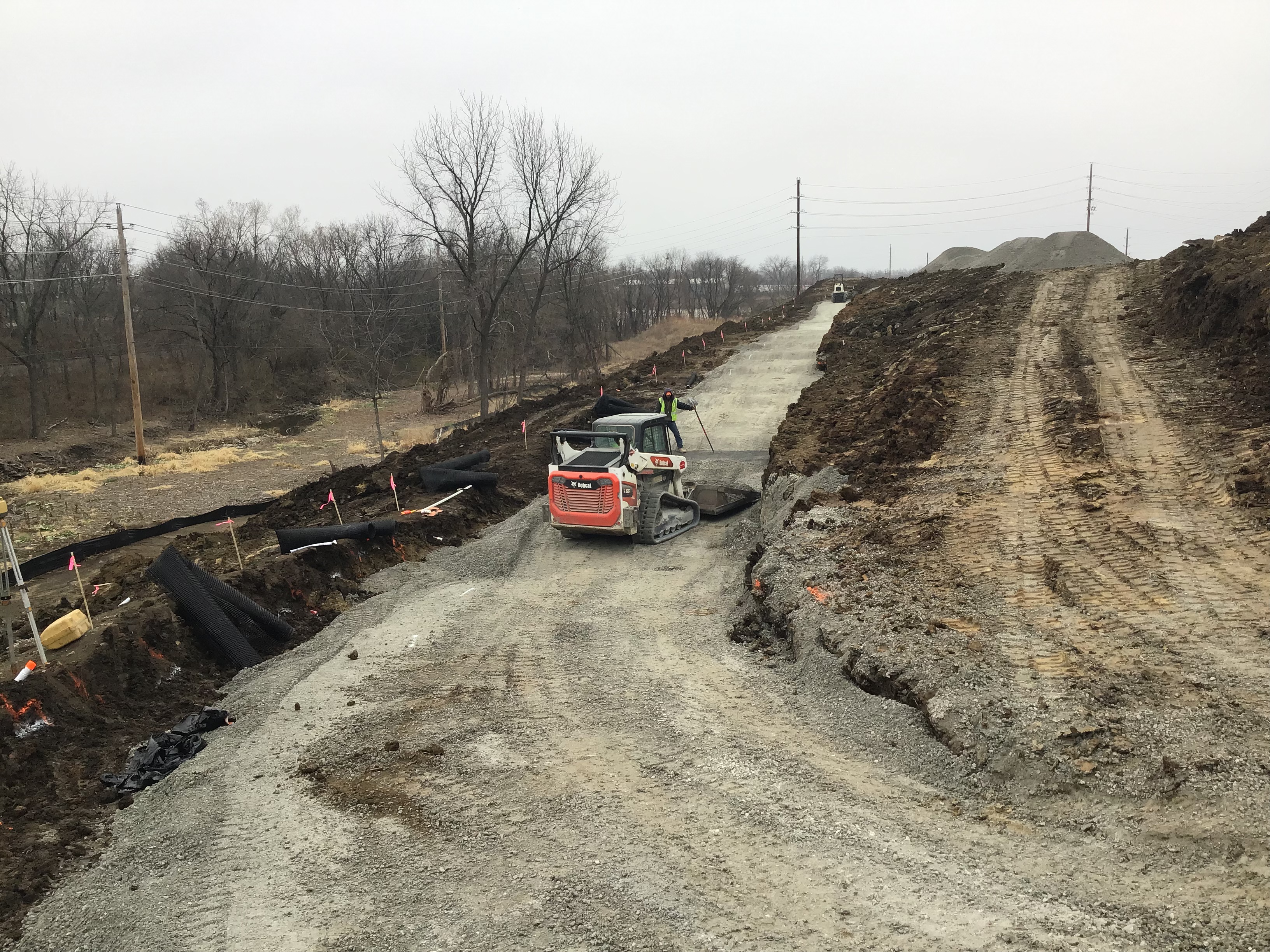

06/10/2022 image4
06/10/2022 Letter INSPECTION SUMMARY
06/13/2022 Letter INSPECTION SUMMARY
06/13/2022 Letter INSPECTION SUMMARY
06/16/2022 Letter INSPECTION SUMMARY

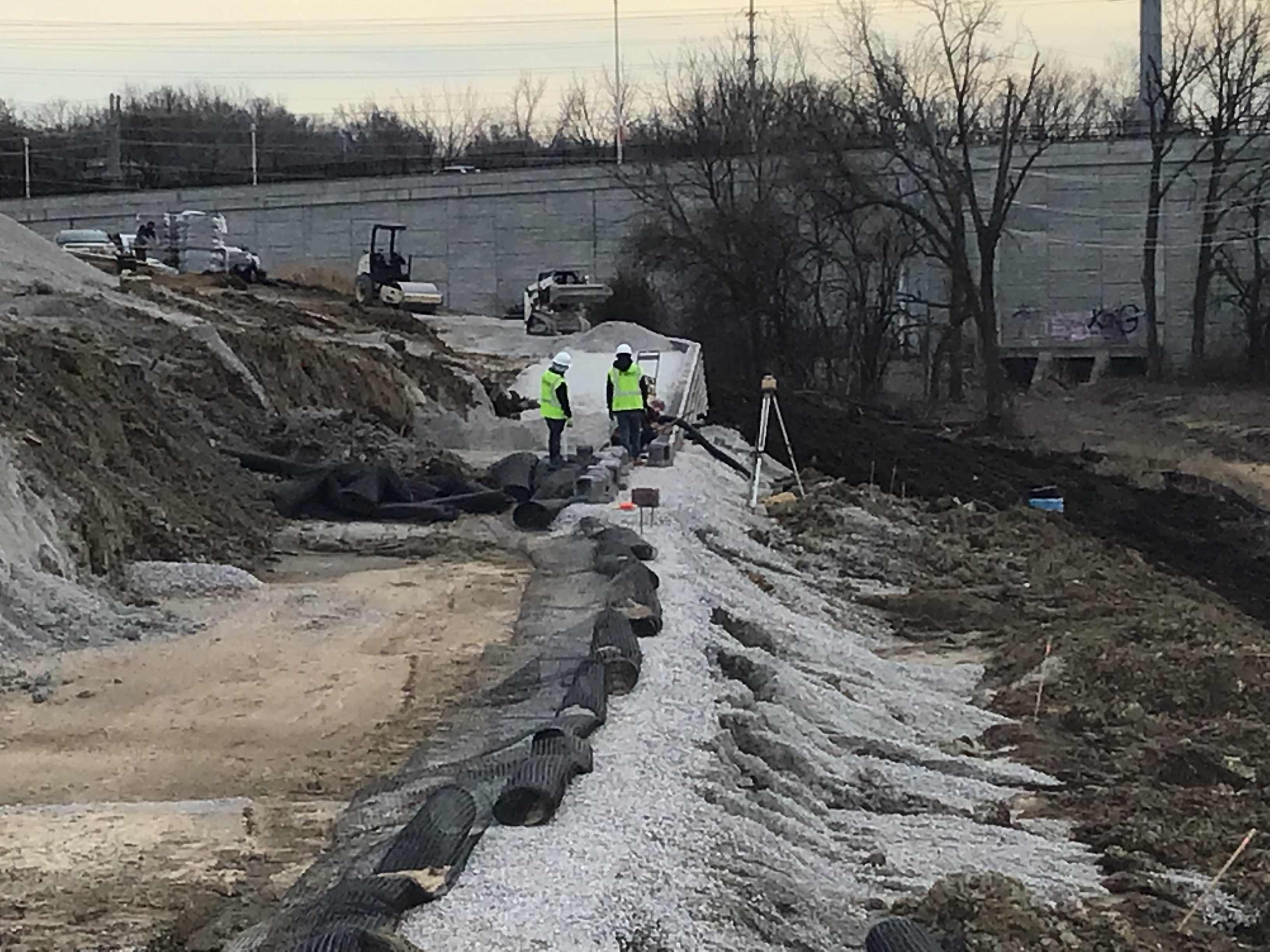

06/21/2022 67752003237__233250D3-B393-423F-9AFD-98DD8BED33CC
06/22/2022 image7
06/27/2022 Receipt Receipt for transaction: 2022-005172
06/27/2022 Approved Plans Lees Summit Commerce Center - water approved 6.27.22
06/27/2022 Approved Plans Lees Summit Commerce Center - street and storm approved 6.27.22

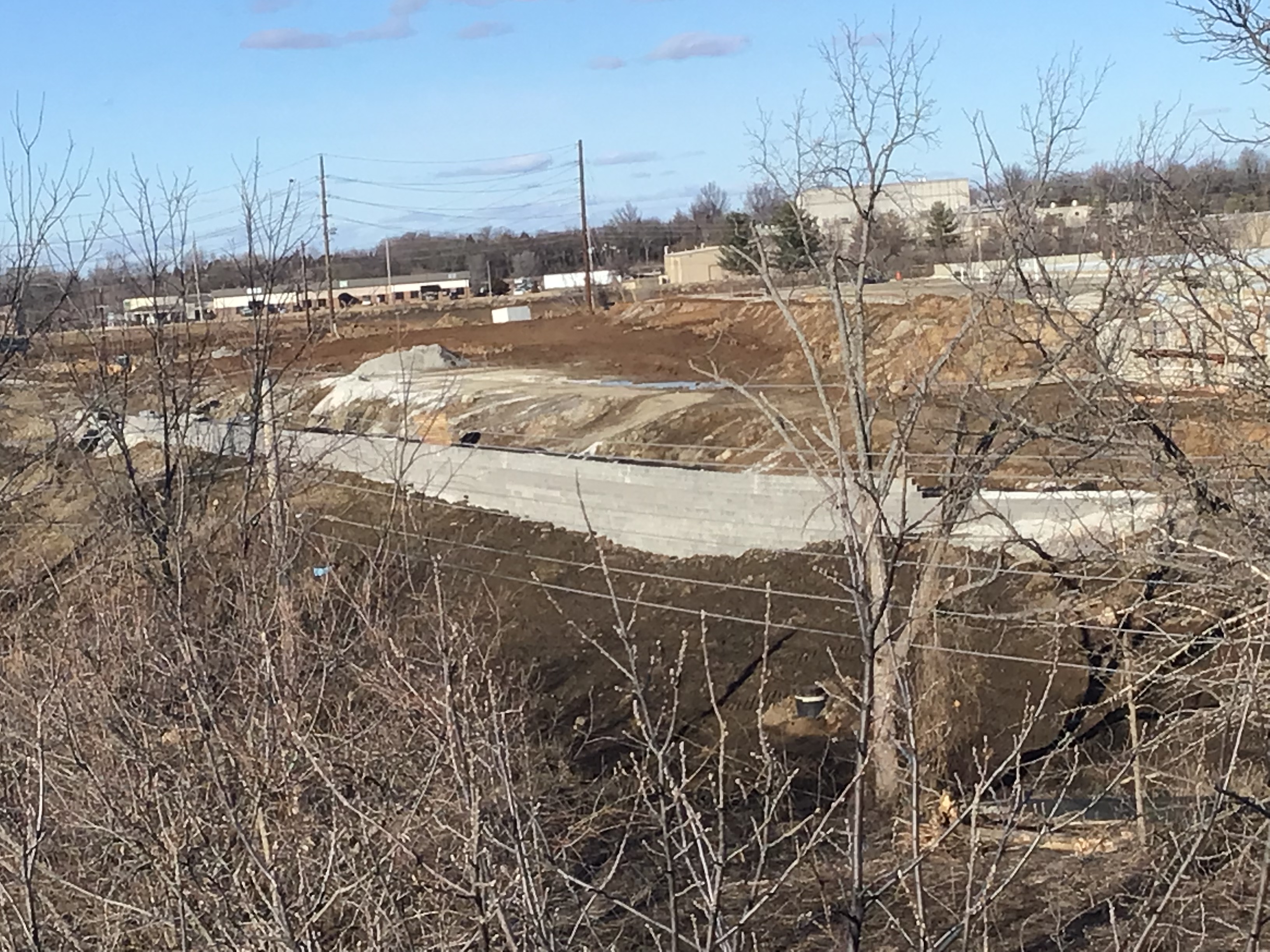

06/30/2022 image8
07/05/2022 Letter INSPECTION SUMMARY
07/06/2022 Letter INSPECTION SUMMARY
07/07/2022 Letter INSPECTION SUMMARY

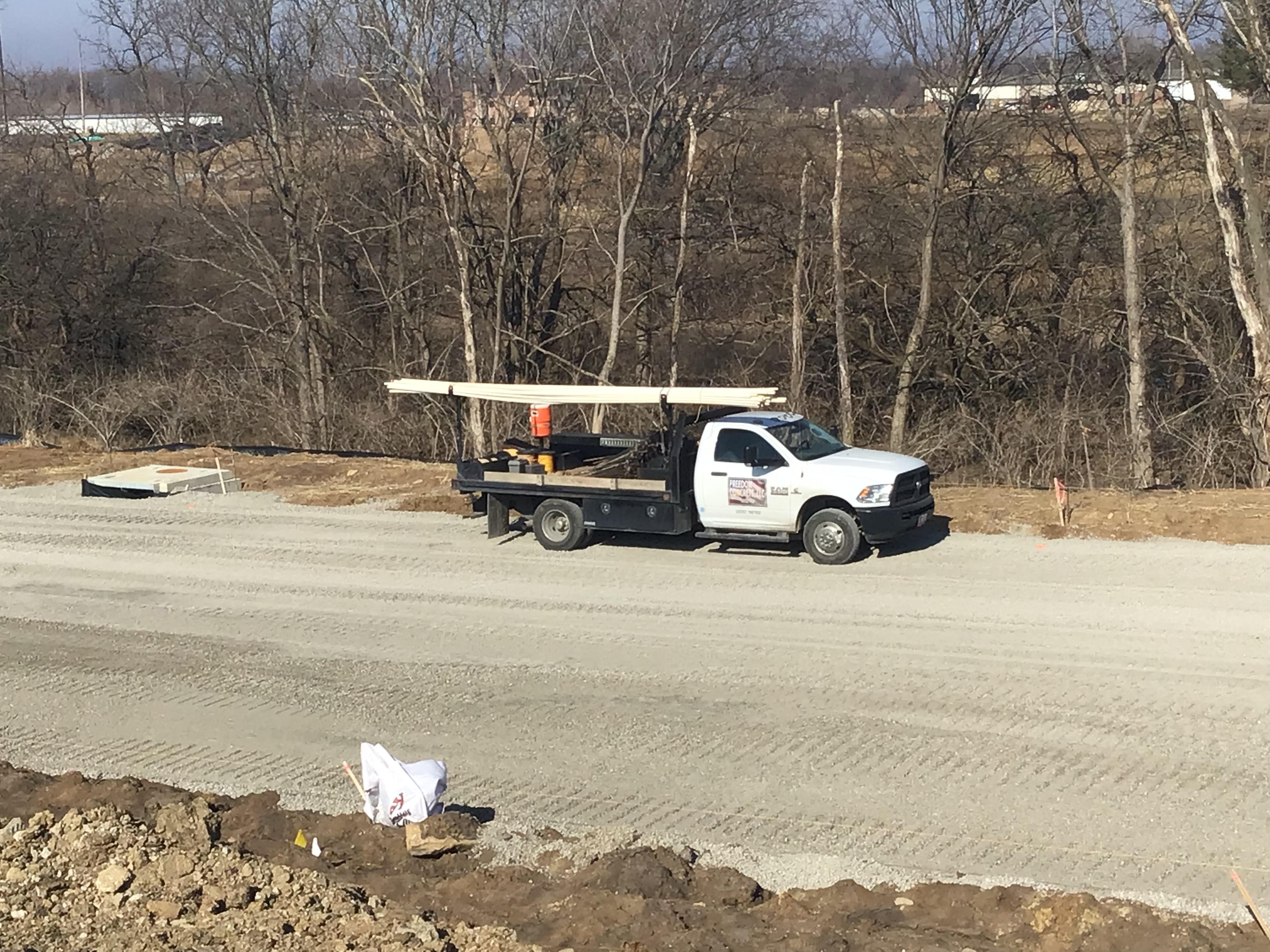

07/07/2022 image9
07/07/2022 image10
07/07/2022 Letter INSPECTION SUMMARY
07/08/2022 image11
07/14/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY
07/20/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter INSPECTION SUMMARY
09/01/2022 Letter INSPECTION SUMMARY
09/01/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
12/08/2022 Letter INSPECTION SUMMARY

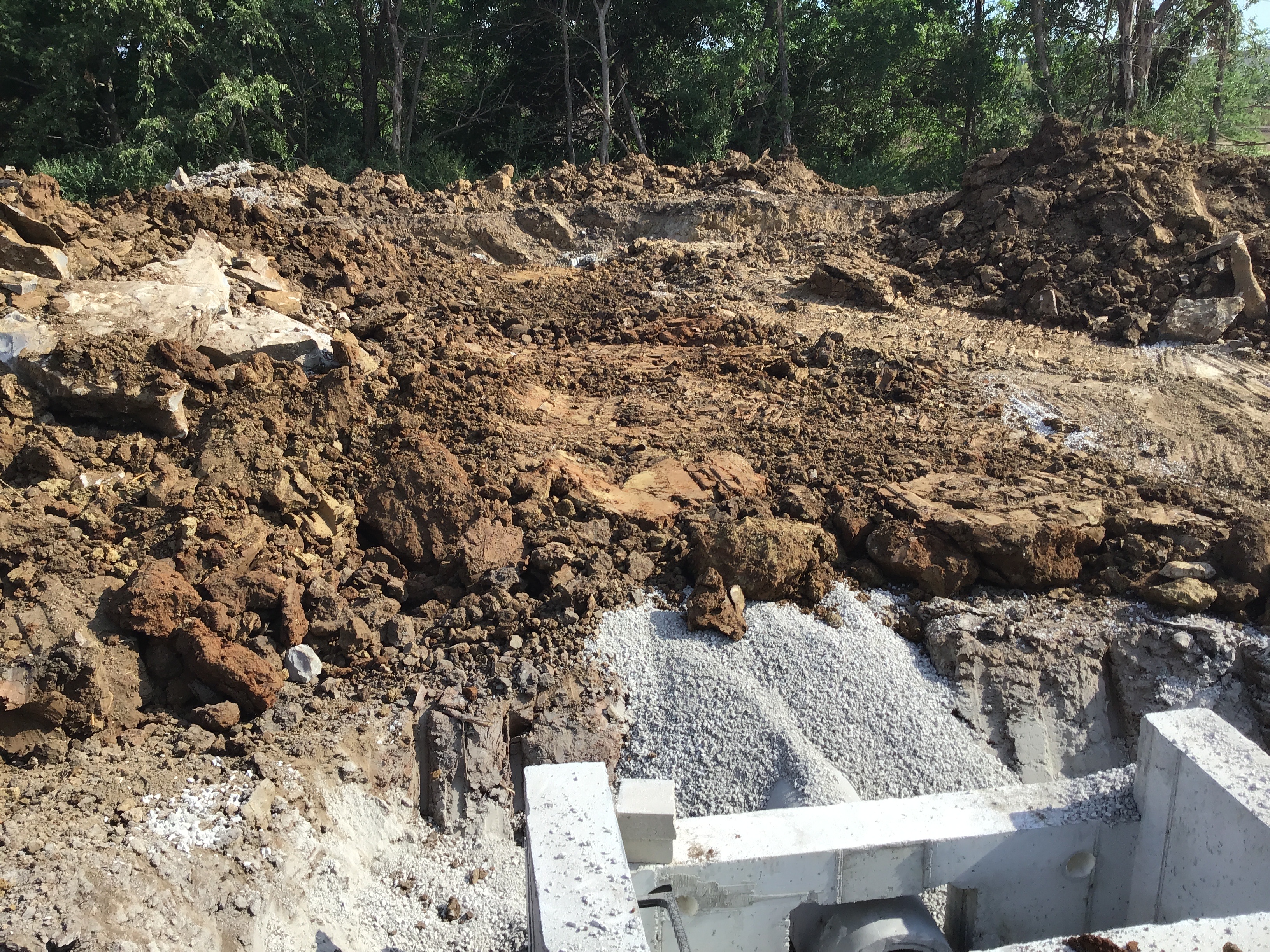

12/08/2022 Installation Foundation for Retaining Wall for the South Building
12/08/2022 Letter INSPECTION SUMMARY
12/09/2022 Letter INSPECTION SUMMARY
12/09/2022 Letter INSPECTION SUMMARY
12/09/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/15/2022 Letter INSPECTION SUMMARY
12/15/2022 Tigger to install 12’X8’ sectional pieces of Storm Line
12/15/2022 Letter INSPECTION SUMMARY
12/15/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY

01/05/2023 Foundation Brick Row (First) of Retaining Wall
01/05/2023 Letter INSPECTION SUMMARY
01/06/2023 Letter INSPECTION SUMMARY
01/09/2023 23 Monday
01/09/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY
01/10/2023 Letter INSPECTION SUMMARY

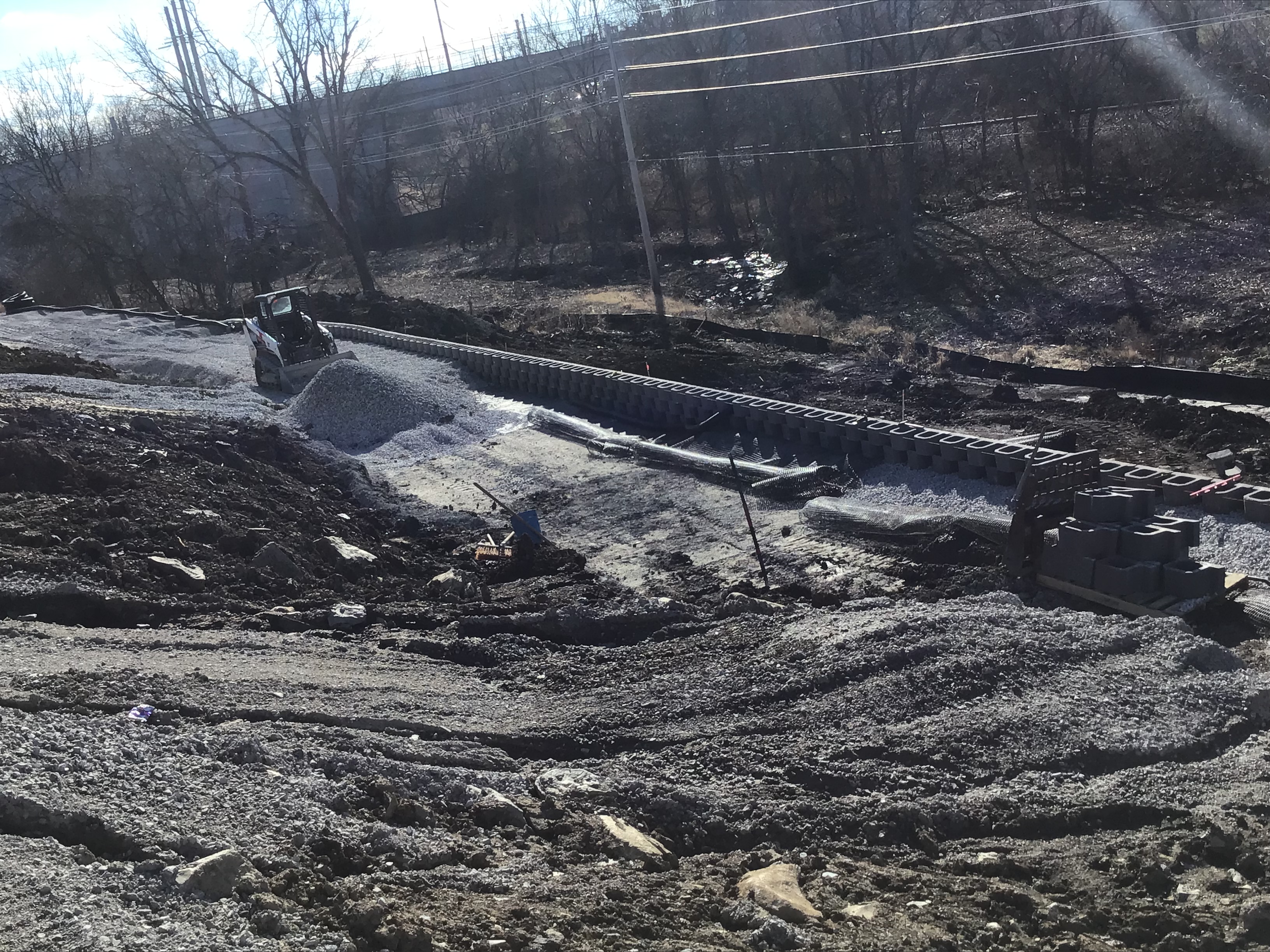

01/11/2023 Retaining Wall
01/11/2023 Letter INSPECTION SUMMARY
01/13/2023 Retaining Wall Friday 13
01/13/2023 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/16/2023 Letter INSPECTION SUMMARY
01/17/2023 IMG_1313 Retaining Wall Construction
01/17/2023 Letter INSPECTION SUMMARY
01/17/2023 String Lining & Grading #1
01/17/2023 String Lining & Grading #2
01/17/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/18/2023 Letter INSPECTION SUMMARY
01/20/2023 23
01/20/2023 24
01/20/2023 25
01/20/2023 Letter INSPECTION SUMMARY
01/23/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/26/2023 Letter INSPECTION SUMMARY
01/27/2023 23 Friday
01/27/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/13/2023 Letter INSPECTION SUMMARY
03/13/2023 Letter INSPECTION SUMMARY
03/14/2023 Letter INSPECTION SUMMARY
03/28/2023 Letter INSPECTION SUMMARY
03/28/2023 Letter INSPECTION SUMMARY
03/28/2023 Letter INSPECTION SUMMARY
03/29/2023 Connecting to 12 Water Main Northside of project
03/29/2023 Letter INSPECTION SUMMARY
03/30/2023 Letter INSPECTION SUMMARY
03/31/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/20/2023 Letter INSPECTION SUMMARY
05/16/2023 Letter INSPECTION SUMMARY
05/17/2023 Letter INSPECTION SUMMARY
05/17/2023 Letter INSPECTION SUMMARY
05/18/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter INSPECTION SUMMARY
05/25/2023 Letter INSPECTION SUMMARY
05/26/2023 Commerce Rd Tie-in 12 and Gate Valve
05/26/2023 Commerce Installing Water under Storm
05/26/2023 Commerce 8 Water
05/26/2023 Letter INSPECTION SUMMARY
05/30/2023 Letter INSPECTION SUMMARY
06/01/2023 Letter INSPECTION SUMMARY
06/01/2023 Letter INSPECTION SUMMARY
06/02/2023 Letter INSPECTION SUMMARY
06/05/2023 Letter INSPECTION SUMMARY
06/06/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/09/2023 (1st Bacteria Samples) Work Order 1GF0774 - City of Lee's Summit - Commerce CenterLogistics
06/09/2023 Letter INSPECTION SUMMARY
06/13/2023 (2nd Bacteria Samples) Work Order 1GF0960 - City of Lee's Summit - Commerce Center
06/13/2023 Letter INSPECTION SUMMARY
06/13/2023 Letter INSPECTION SUMMARY
06/16/2023 Letter INSPECTION SUMMARY
06/27/2023 Letter INSPECTION SUMMARY
06/29/2023 Pavement-Aggregate Base first ticket
06/29/2023 Letter INSPECTION SUMMARY
06/29/2023 Letter INSPECTION SUMMARY
07/01/2023 Letter INSPECTION SUMMARY
07/01/2023 Re Asphalt Base Tickets Last for Yesterday and First Last Today
07/06/2023 Letter INSPECTION SUMMARY
07/11/2023 Letter INSPECTION SUMMARY
07/12/2023 Letter INSPECTION SUMMARY
07/28/2023 Letter INSPECTION SUMMARY
07/28/2023 Letter INSPECTION SUMMARY
08/15/2023 Letter INSPECTION SUMMARY
08/16/2023 Letter INSPECTION SUMMARY
08/16/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/18/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
09/15/2023 Letter INSPECTION SUMMARY
09/25/2023 Letter INSPECTION SUMMARY
09/28/2023 Letter INSPECTION SUMMARY
10/05/2023 Letter INSPECTION SUMMARY
10/19/2023 Letter INSPECTION SUMMARY
10/19/2023 Letter INSPECTION SUMMARY
10/26/2023 Letter DE-Certificate of Substantial Completion Single Lot
10/26/2023 Letter DE-Punch List
10/27/2023 Letter INSPECTION SUMMARY
11/02/2023 Sidewalk Bond
11/01/2023 Plans 2023-10-30_Public Watermain Plans _Record Drawings
11/01/2023 Plans Record Drawings - Street and Storm_Rev_0_PL2021409
11/07/2023 Letter INSPECTION SUMMARY
11/10/2023 Letter INSPECTION SUMMARY
11/15/2023 Receipt Receipt for transaction:2023-008523
11/21/2023 Letter INSPECTION SUMMARY
12/01/2023 Letter DE-Certificate of Substantial Completion Single Lot
12/12/2023 Letter INSPECTION SUMMARY
12/12/2023 Letter INSPECTION SUMMARY
01/03/2024 Letter INSPECTION SUMMARY
01/03/2024 Letter INSPECTION SUMMARY
01/05/2024 Letter INSPECTION SUMMARY
01/05/2024 Letter INSPECTION SUMMARY
01/05/2024 Letter INSPECTION SUMMARY
01/23/2024 Letter Lee's Summit Commerce Center Public Infastructure Certificate of Substantial Completion
02/13/2024 Security Document 3 YEAR MAINTENANCE BOND
02/15/2024 Plans Record Drawings - Street and Storm_Rev_1_PL2021409
06/27/2024 Activity Document LSCC Infra - Final Affidavit (94899862v1)
06/27/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
