Summary

PRSUBD20203605
Public Infrastructure
Substantial Completion
ORCHARD PARK DEVELOPMENT LLC
DEVELOPMENT COMPLETE
Full infrustructure for the development
10/08/2020
11/04/2020
Locations
Contacts
ORCHARD PARK DEVELOPMENT LLC, Address:8 SW AA HWY
ORCHARD PARK DEVELOPMENT LLC, Address:8 SW AA HWY
RENAISSANCE INFRASTRUCTURE CONSULTING INC, Address:8653 PENROSE LN, Phone:(913) 317-9500
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 10/08/2020 11/04/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 10/29/2020
91100C8-Sanitary Sewer Insp Fees $3,716.91 $3,716.91 Paid 10/29/2020
91100C9-Water Insp Fee $1,568.43 $1,568.43 Paid 10/29/2020
9110072-Water Test Fee $400.00 $400.00 Paid 10/29/2020
9110068-Storm Fee $1,103.31 $1,103.31 Paid 10/29/2020
9110081-Paved Surface Inspection Fee $3,292.29 $3,292.29 Paid 10/29/2020
9110071-Site Grading Fee $1,923.87 $1,923.87 Paid 10/29/2020
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid

$50.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 11/11/2020
Misc
Informational
11/11/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week.
Storm - Pipe Partial 11/13/2020 11/13/2020 11/13/2020
Misc
Informational
11/12/2020
11-12-20 9:43am They didn’t get enough rock installed. They will make the corrections. 11-13-20 10:14am They have plenty of rock around the storm pipe.
Site Visit Partial 11/16/2020
Misc
Informational
11/11/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing.
Storm - Pipe Partial 11/16/2020 11/16/2020 11/17/2020
Misc
Informational
11/13/2020
11-12-20 9:43am They didn’t get enough rock installed. They will make the corrections. 11-13-20 10:14am They have plenty of rock around the storm pipe. 11-17-20 They are working on the detention basin.
Misc
Informational
06/27/2022
06/27/22 (Justin) I was informed by the developer today that contractor had repaired the damaged RCP storm pipe on the Southwest side of NW Olive Street & NW Orchard Street. I physically exam repair and test the structure with my body weight of approximately 235lbs. Repair appear to be structural sound. 07/27/22 Contractor installed 80’ of 15”HDPE and the storm box on the Eastside of building project.
Detention Basin Partial 11/17/2020
Misc
Informational
11/17/2020
11-17-20 2:05pm They are installing the storm pipe on the West side of the pipe. They have rip rap installed. They are making changes and will have the engineer turn in as-builds.
Water Line - Construction Inspection Partial 11/18/2020 11/18/2020 11/18/2020
Misc
Informational
11/18/2020
11-18-20 10:38am Howerton Plumbing are digging up to start installing water line. They are starting at the fire hydrant and working to the main. They talked to the developer and he informed them that the detention basin is built to plan. 2:19pm Howerton has dug out for water pipe and have installed one stick of pipe.
Water Line - Construction Inspection Partial 11/19/2020 11/19/2020 11/19/2020
Misc
Informational
11/19/2020
11-19-20 8:46am They are placing rock and will installing water line later. 11:20am They have installed approximately 60’ of water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks at 9am 11-20-20.
Water Line - Construction Inspection Partial 11/20/2020 11/20/2020 11/20/2020
Misc
Informational
11/19/2020
11-19-20 8:46am They are placing rock and will installing water line later. 11:20am They have installed approximately 60’ of water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks at 9am 11-20-20. 11-20-20 7:15am They are setting up and will be pouring thrust blocks. They have a total of 360’ of water line installed and thrust blocks are poured. They will be rocking and backfilling.
Site Visit Partial 11/23/2020 11/23/2020 11/23/2020
Misc
Informational
11/16/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time.
Erosion Control Inspection Partial 11/23/2020 11/23/2020 11/23/2020
Misc
Informational
11/23/2020
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time.
Site Visit Partial 11/24/2020 11/24/2020 11/24/2020
Misc
Informational
11/23/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today.
Erosion Control Inspection Partial 11/25/2020
Misc
Informational
11/23/2020
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time.
Site Visit Partial 11/30/2020 11/30/2020 11/30/2020
Misc
Informational
11/24/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole.
Water Line - Construction Inspection Partial 11/30/2020 11/30/2020
Misc
Informational
11/20/2020
11-19-20 8:46am They are placing rock around the water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks a king and backfilling. 11-30-20 9:11am The power company is on site to support a pole to allow Howerton to dig out for the water line. 11:03 am They have dug out for the water line and installed the rock. They will install the water line and call for a inspection. 2:15pm They have the water line installed and are covering with rock.
Site Visit Partial 12/04/2020
Misc
Informational
11/30/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital.
Site Visit Partial 12/7/2020 12/7/2020 12/07/2020
Misc
Informational
12/04/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today.
Site Visit Partial 12/08/2020
Misc
Informational
12/07/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time.
Site Visit Partial 12/9/2020 12/9/2020 12/09/2020
Misc
Informational
12/08/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place.
Sanitary - Material Verification Passed 12/09/2020
Misc
Informational
12/09/2020
12-9-20 10:03am SDR26 is on site. All materials on site appear to be correct for the project.
Water Line - Construction Inspection Partial 12/10/2020 12/10/2020 12/10/2020
Misc
Informational
11/30/2020
11-19-20 8:46am They are placing rock around the water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks a king and backfilling. 11-30-20 9:11am The power company is on site to support a pole to allow Howerton to dig out for the water line. 11:03 am They have dug out for the water line and installed the rock. They will install the water line and call for a inspection. 2:15pm They have the water line installed and are covering with rock. 12-9-20 1:32pm Howerton Plumbing is installing approximately 20’ of water line and a valve. 12-10-20 8:46am Howerton are working on moving the fire hydrant and connecting the water line. 2:10pm They have poured the trust blocks and are started backfilling.
Site Visit Partial 12/11/2020 12/11/2020 12/11/2020
Misc
Informational
12/09/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather.
Site Visit Partial 12/14/2020 12/14/2020 12/14/2020
Misc
Informational
12/11/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time.
Site Visit Partial 12/14/2020
Misc
Informational
12/14/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am.
Site Visit Partial 12/15/2020 12/15/2020 12/15/2020
Misc
Informational
12/14/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow.
Site Visit Partial 12/16/2020
Misc
Informational
12/15/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today.
Sanitary Sewer Construction Inspection Partial 12/16/2020 12/16/2020 12/16/2020
Misc
Informational
12/16/2020
12-16-20 2:10pm Howerton is placing manhole 1-A.
Misc
Informational
12/16/2020
12-16-20 2:10pm Howerton is placing manhole 1-A.
Misc
Informational
12/16/2020
12-16-20 2:10pm Howerton is placing manhole 1-A.
Water Line - Hydrostatic Test Passed 12/16/2020 12/16/2020 12/16/2020
Misc
Informational
12/16/2020
12-16-20 1:10pm Howerton Plumbing are working on getting the hydrostatic test set up.
Misc
Informational
12/16/2020
12-16-20 1:10pm Howerton Plumbing are working on getting the hydrostatic test set up. We started the test at 1:30pm it has been two hours and it has held at 150 psi. This is a pass.
Sanitary Sewer Construction Inspection Partial 12/17/2020 12/17/2020 12/17/2020
Misc
Informational
12/17/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole.
Water Line - Construction Inspection Partial 12/17/2020 12/17/2020 12/17/2020
Misc
Informational
12/10/2020
11-19-20 8:46am They are placing rock around the water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks a king and backfilling. 11-30-20 9:11am The power company is on site to support a pole to allow Howerton to dig out for the water line. 11:03 am They have dug out for the water line and installed the rock. They will install the water line and call for a inspection. 2:15pm They have the water line installed and are covering with rock. 12-9-20 1:32pm Howerton Plumbing is installing approximately 20’ of water line and a valve. 12-10-20 8:46am Howerton are working on moving the fire hydrant and connecting the water line. 2:10pm They have poured the trust blocks and are started backfilling. 12-17-20 8:47am The contractor will be connecting the water and moving the fire hydrant today. The fire hydrant has a leak. Steve Robbins is checking with the Water Department for direction.
Water Line - Construction Inspection Partial 12/18/2020 12/18/2020 12/18/2020
Misc
Informational
12/17/2020
11-19-20 8:46am They are placing rock around the water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks a king and backfilling. 11-30-20 9:11am The power company is on site to support a pole to allow Howerton to dig out for the water line. 11:03 am They have dug out for the water line and installed the rock. They will install the water line and call for a inspection. 2:15pm They have the water line installed and are covering with rock. 12-9-20 1:32pm Howerton Plumbing is installing approximately 20’ of water line and a valve. 12-10-20 8:46am Howerton are working on moving the fire hydrant and connecting the water line. 2:10pm They have poured the trust blocks and are started backfilling. 12-17-20 8:47am The contractor will be connecting the water and moving the fire hydrant today. The fire hydrant has a leak. Steve Robbins is checking with the Water Department for direction. 12-18-20 Howerton is getting set up to flush the water main. We will start this at approximately 10:30am. 11:27am Howerton has flushed the line free of chlorine. We will pull samples Monday the 21st. 11/10/21 Wednesday (Howerton Const.) Contractor raised valve stand for hydrant to existing grade.
Sanitary Sewer Construction Inspection Partial 12/18/2020 12/18/2020 12/18/2020
Misc
Informational
12/17/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2.
Water Line - Coliform Test 1 Partial 12/21/2020 12/21/2020 12/21/2020
Misc
Informational
12/21/2020
12-21-20 9:29am Howerton is preparing to pull the water sample. 9:55am The sample has been pulled and I am on my way to the lab.
Sanitary Sewer Construction Inspection Partial 12/21/2020 12/21/2020 12/21/2020
Misc
Informational
12/18/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it.
Water Line - Coliform Test 2 Partial 12/22/2020 12/22/2020 12/22/2020
Misc
Informational
12/22/2020
12-22-20 10:42am We pulled the sample at 9:50am and I have dropped the sample off. 11:25am I am back at Lee’s Summit.
Water Line - Coliform Test 1 Passed 12/23/2020
Misc
Informational
12/21/2020
12-21-20 9:29am Howerton is preparing to pull the water sample. 9:55am The sample has been pulled and I am on my way to the lab.
Sanitary Sewer Construction Inspection Partial 12/23/2020
Misc
Informational
12/21/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Ke nt Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling.
Water Line - Coliform Test 2 Passed 12/28/2020
Misc
Informational
12/22/2020
12-22-20 10:42am We pulled the sample at 9:50am and I have dropped the sample off. 11:25am I am back at Lee’s Summit.
Site Visit Partial 12/28/2020 12/28/2020 12/28/2020
Misc
Informational
12/16/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary.
Sanitary Sewer Construction Inspection Partial 12/28/2020 12/28/2020 12/28/2020
Misc
Informational
12/23/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks.
Sanitary Sewer Construction Inspection Partial 12/29/2020 12/29/2020 12/29/2020
Misc
Informational
12/28/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day.
Site Visit Partial 12/31/2020
Misc
Informational
12/28/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today.
Site Visit Partial 1/5/2021 1/5/2021 01/05/2021
Misc
Informational
12/31/2020
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather.
Site Visit Partial 1/11/2021 1/11/2021 01/11/2021
Misc
Informational
01/05/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time.
Sanitary Sewer Construction Inspection Partial 1/12/2021 1/12/2021 01/12/2021
Misc
Informational
12/29/2020
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes.
Sanitary Sewer Construction Inspection Partial 1/13/2021 1/13/2021 01/13/2021
Misc
Informational
01/12/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one.
Sanitary Sewer Construction Inspection Partial 1/14/2021 1/14/2021 01/14/2021
Misc
Informational
01/13/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day.
Sanitary Sewer Construction Inspection Partial 1/19/2021 1/19/2021 01/19/2021
Misc
Informational
01/14/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts.
Sanitary Sewer Construction Inspection Partial 1/20/2021 1/20/2021 01/20/2021
Misc
Informational
01/19/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing.
Sanitary Sewer Construction Inspection Partial 01/21/2021
Misc
Informational
01/20/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material.
Site Visit Partial 01/25/2021
Misc
Informational
01/11/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place.
Site Visit Partial 01/26/2021
Misc
Informational
01/25/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow.
Site Visit Partial 1/29/2021 1/29/2021 01/29/2021
Misc
Informational
01/26/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site.
Site Visit Partial 2/1/2021 2/1/2021 02/01/2021
Misc
Informational
01/29/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time.
Sanitary Sewer Construction Inspection Partial 2/2/2021 2/2/2021 02/02/2021
Misc
Informational
01/21/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material. 2-2-21 9:03am Howerton will be backfilling today. Terracon is on site for testing. 10:30am They can not get compaction. They will try again at a later date.
Site Visit Partial 2/3/2021 2/3/2021 02/03/2021
Misc
Informational
02/01/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling.
Sanitary Sewer Construction Inspection Partial 2/5/2021 2/5/2021 02/05/2021
Misc
Informational
02/02/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material. 2-2-21 9:03am Howerton will be backfilling today. Terracon is on site for testing. 10:30am They can not get compaction. They will try again at a later date. 2-5-21 11:12am They are backfilling the sanitary main. Terracon is on site for testing. They are meeting compaction with 98 percent so far.
Site Visit Partial 02/08/2021
Misc
Informational
02/03/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather.
Site Visit Partial 02/09/2021
Misc
Informational
02/08/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues.
Site Visit Partial 2/10/2021 2/10/2021 02/10/2021
Misc
Informational
02/09/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place.
Site Visit Partial 02/18/2021
Misc
Informational
02/10/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow.
Site Visit Partial 2/22/2021 2/22/2021 02/22/2021
Misc
Informational
02/18/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place.
Site Visit Partial 2/24/2021 02/24/2021
Misc
Informational
02/22/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today.
Site Visit Partial 2/25/2021 02/25/2021
Misc
Informational
02/24/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues.
Site Visit Partial 03/01/2021
Misc
Informational
02/25/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site.
Site Visit Partial 03/03/2021
Misc
Informational
03/01/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean.,
Site Visit Partial 3/3/2021 3/3/2021 03/03/2021
Misc
Informational
03/03/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean.,
Site Visit Partial 03/04/2021
Misc
Informational
03/03/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean.
Site Visit Partial 3/5/2021 3/5/2021 03/05/2021
Misc
Informational
03/04/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean.
Site Visit Partial 03/08/2021
Misc
Informational
03/05/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main.
Sanitary Sewer Construction Inspection Partial 03/08/2021
Misc
Informational
02/05/2021

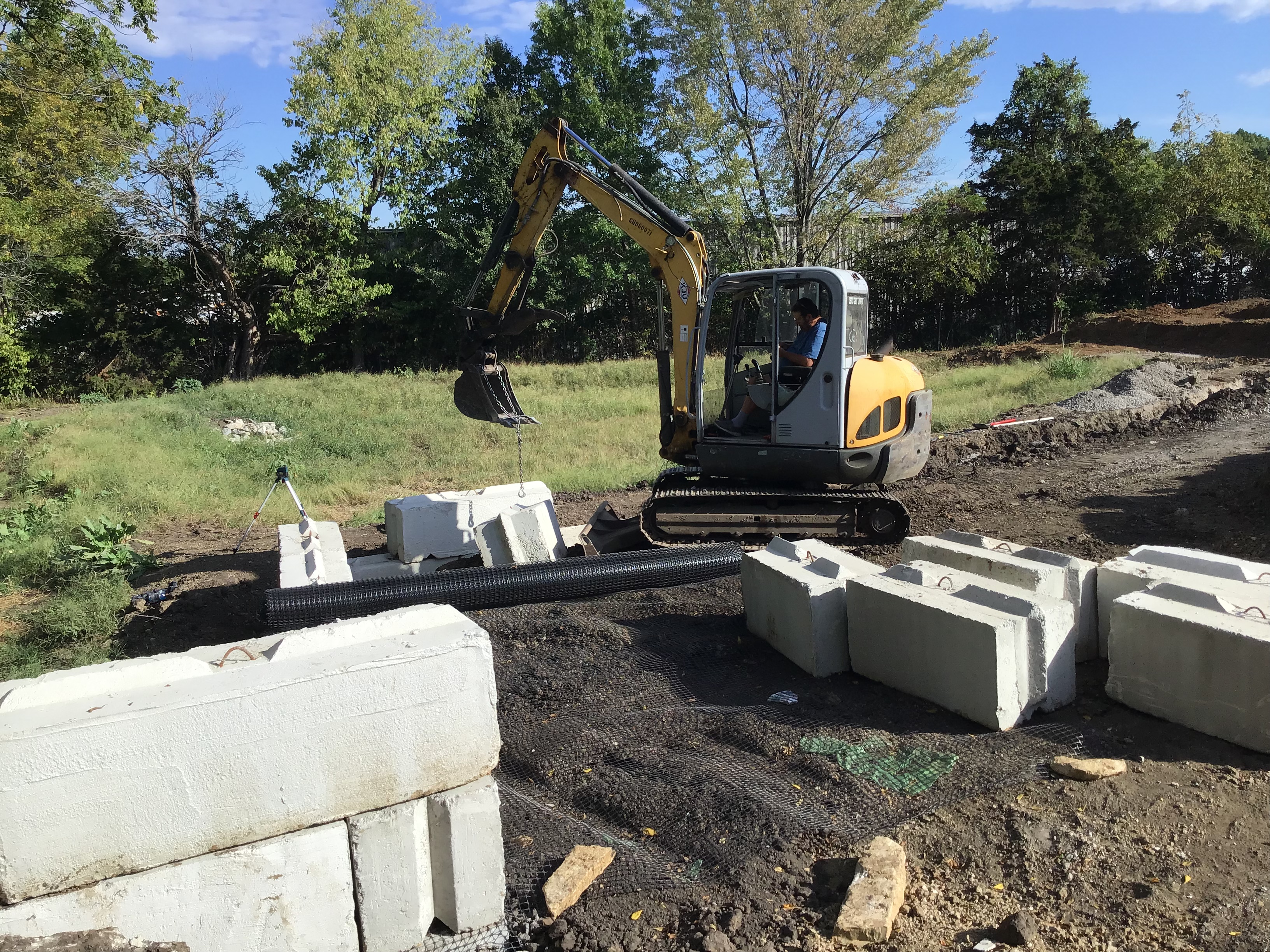

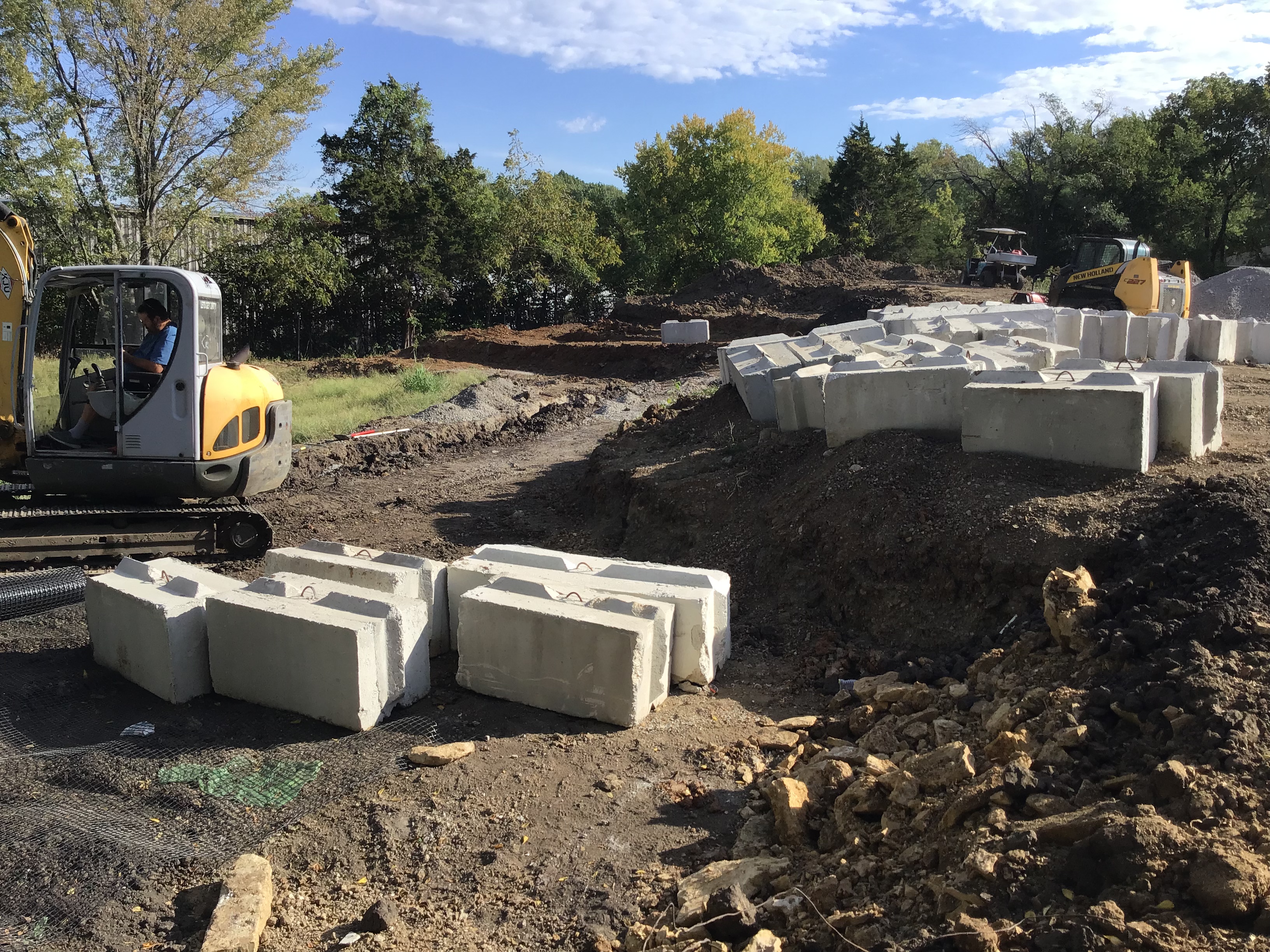

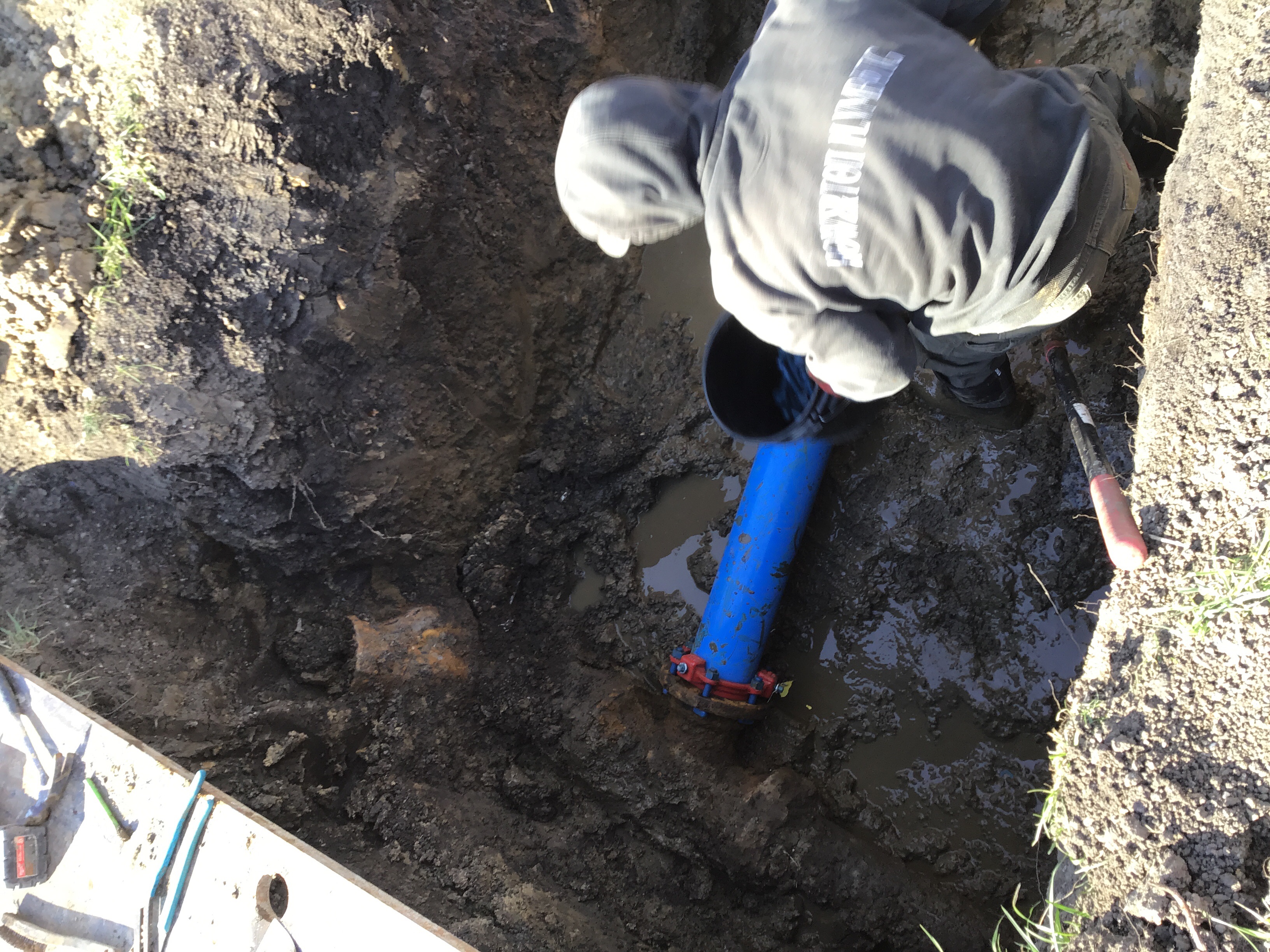

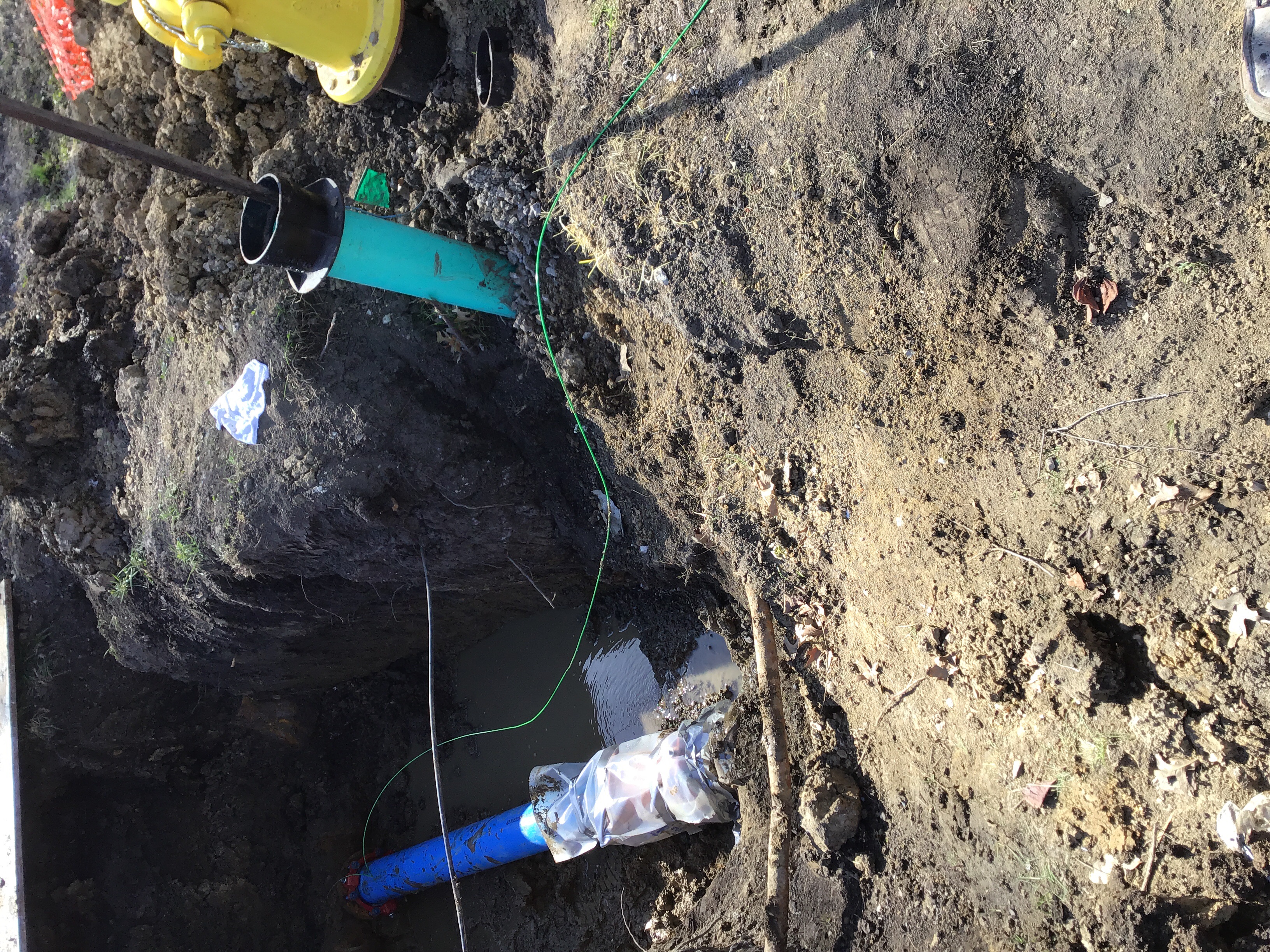

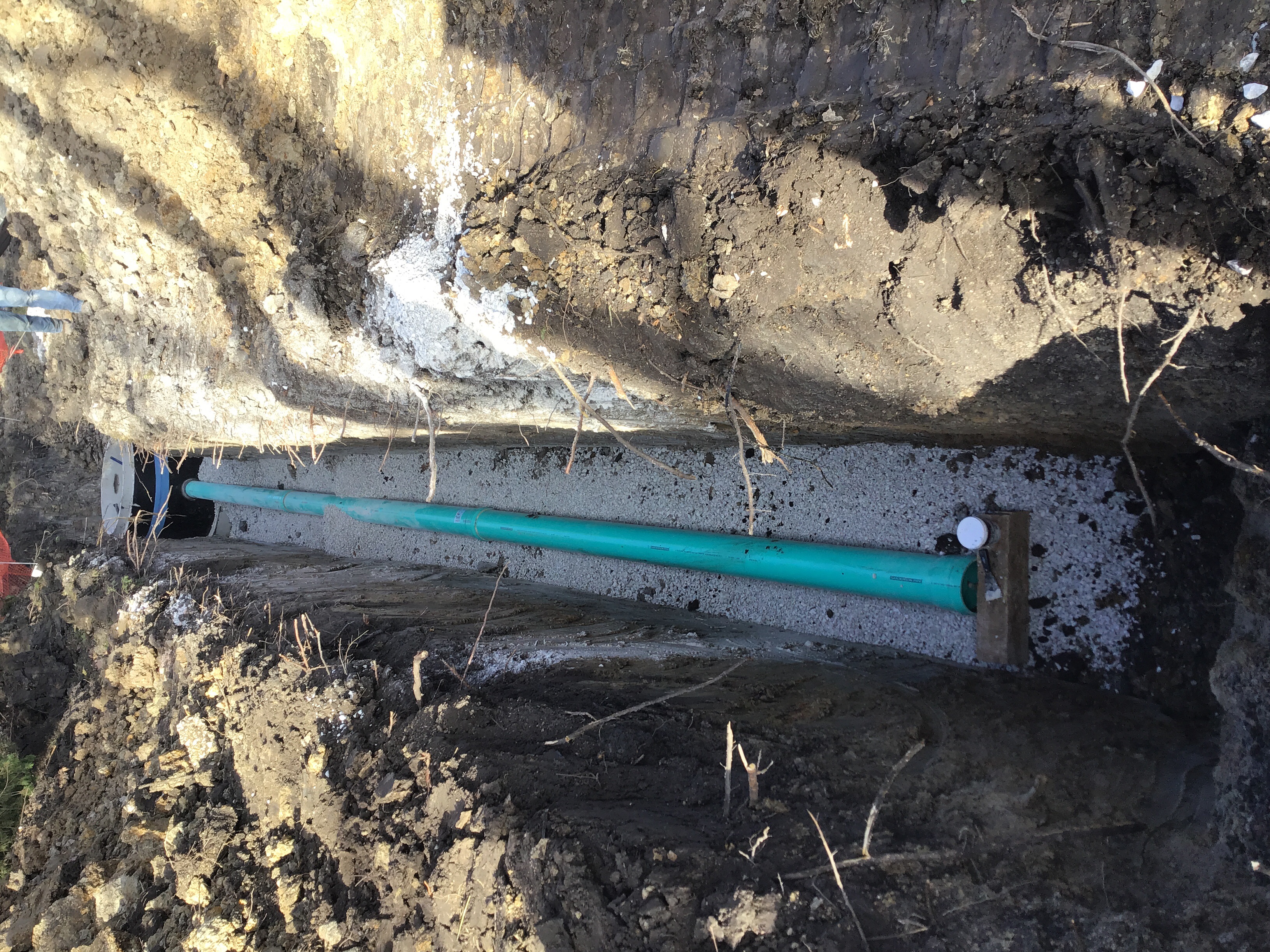

12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material. 2-2-21 9:03am Howerton will be backfilling today. Terracon is on site for testing. 10:30am They can not get compaction. They will try again at a later date. 2-5-21 11:12am They are backfilling the sanitary main. Terracon is on site for testing. They are meeting compaction with 98 percent so far. 3-8-21 3:27pm They have installed three service lines and are now backfilling.
Sanitary Sewer Construction Inspection Partial 3/9/2021 3/9/2021 03/09/2021
Misc
Informational
03/08/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material. 2-2-21 9:03am Howerton will be backfilling today. Terracon is on site for testing. 10:30am They can not get compaction. They will try again at a later date. 2-5-21 11:12am They are backfilling the sanitary main. Terracon is on site for testing. They are meeting compaction with 98 percent so far. 3-8-21 3:27pm They have installed three service lines and are now backfilling. 3-9-21 9:09am Howerton is on site backfilling the service lines. They will be getting compaction testing done.
Site Visit Partial 03/10/2021
Misc
Informational
03/08/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time.
Site Visit Partial 03/12/2021
Misc
Informational
03/10/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean.
Site Visit Partial 3/15/2021 3/15/2021 03/15/2021
Misc
Informational
03/12/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site.
Erosion Control Inspection Partial 3/16/2021 3/16/2021 03/16/2021
Misc
Informational
11/25/2020
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time. 3-16-21 9:04am There is a section of silt fence down but it is not causing any issues.
Erosion Control Inspection Partial 3/18/2021 3/18/2021 03/18/2021
Misc
Informational
03/16/2021
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time. 3-16-21 9:04am There is a section of silt fence down but it is not causing any issues. 3-18-21 2:12pm There is silt fence down but it is not effecting erosion controls at this time.
Sanitary Sewer Construction Inspection Partial 03/19/2021
Misc
Informational
03/09/2021
12-17-20 They set manhole A-1 and ran 14’ of sanitary line into the existing manhole. 12-18-20 2:06pm They have installed 42’ of sanitary line at this time and are backfilling. They are working to manhole A-2. 12-21-20 3:13am They have installed approximately 45’ of sanitary line. The line has a curve in it and it should be straight. Kent Monter is looking into it. 12-23-20 1:55pm The Water Department came on site and checked the sanitary line. Kent Monter reached out to Ryan Ratcliff and they are goood with the deflection. The contractor will be backfilling. 12-28-20 9:32am Howerton is dingging out to install sanitary line. They have approximately 40’ dug out at this time. 1:41pm They have installed approximately 56’ of sanitary main line. They have two service lines installed and are working on two more. 3:30pm They are pouring trench checks. 12-29-20 11:33am They backfilled two service lines and have left for the day. 1-12-21 7:48am They have dug out and have installed approximately 42’ of sanitary line. 10:53am They have another 40’ installed and six wyes. 1-13-21 10:59AM The 4-A manhole offset is incorrect and they will need to order a new one. 1-14-21 7:56am They are waiting for a new manhole to show for the sanitary. 3:17pm They have the new manhole and have it installed with one stick coming out. They are wrapping up for the day. 1-19-21 They have ran sanitary line to manhole 5-A. 2:06pm They are getting ready to pour trench checks and inverts. 1-20-21 8:30am They have not started backfilling at this time. 1:40pm They will be backfilling tomorrow 1-21-21. They will have a third party inspector on site for compaction testing. 1-21-21 9:37am The trench is 3’ wide. They do not have the right backfill material. 2-2-21 9:03am Howerton will be backfilling today. Terracon is on site for testing. 10:30am They can not get compaction. They will try again at a later date. 2-5-21 11:12am They are backfilling the sanitary main. Terracon is on site for testing. They are meeting compaction with 98 percent so far. 3-8-21 3:27pm They have installed three service lines and are now backfilling. 3-9-21 9:09am Howerton is on site backfilling the service lines. They will be getting compaction testing done. 3-19-21 11:08am Howerton has installed approximately 30’ of sanitary service line and will be backfilling.
Site Visit Partial 03/22/2021
Misc
Informational
03/15/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence.
Erosion Control Inspection Partial 03/23/2021
Misc
Informational
03/18/2021
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time. 3-16-21 9:04am There is a section of silt fence down but it is not causing any issues. 3-18-21 2:12pm There is silt fence down but it is not effecting erosion controls at this time. 3-23-21 2:26pm It is raining and erosion controls are working at this time. The street is clean.
Site Visit Partial 3/26/2021 3/26/2021 03/26/2021
Misc
Informational
03/22/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean.,
Storm Sewer Construction Inspection Partial 3/29/2021 3/29/2021 03/29/2021
Misc
Informational
03/29/2021
3-29-21 9:46am Howerton is digging out to run storm line A and set box A1 and A2. 11:51am The storm boxes wont be delivered today. Howerton will start on digging out for the water tie-in. 11/10/21 Wednesday (Howerton Const.) Contractor began installation of approximately 80” of 12 RCP storm drain. Flowable fill was poured over section of storm pipe that is the propose driveway entrance. The flared end section to the South need to be repaired or replaced (contractor knows he must address this issue).
Site Visit Partial 03/29/2021
Misc
Informational
03/26/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions.
Site Visit Partial 03/30/2021
Misc
Informational
03/29/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now.
Storm Sewer Construction Inspection Partial 03/30/2021
Misc
Informational
03/30/2021
3-30-21 1:59pm Howerton has set the storm boxes A2 and A3. They are getting ready to lay rock to install pipe.
Storm Sewer Construction Inspection Partial 3/31/2021 03/31/2021
Misc
Informational
03/30/2021
3-30-21 1:59pm Howerton has set the storm boxes A2 and A3. They are getting ready to lay rock to install pipe. 3-31-21 9:36am There is no work taking place. They have set the storm pipe and poured one collar and invert on A2. 11/08/21 Friday Howerton Construction 45’ of 12” RCP along NW Olive Street.
Water Line - Construction Inspection Partial 4/1/2021 4/1/2021 04/01/2021
Misc
Informational
12/18/2020
11-19-20 8:46am They are placing rock around the water line. They will be pouring thrust blocks later today. 3:30pm They will be pouring thrust blocks a king and backfilling. 11-30-20 9:11am The power company is on site to support a pole to allow Howerton to dig out for the water line. 11:03 am They have dug out for the water line and installed the rock. They will install the water line and call for a inspection. 2:15pm They have the water line installed and are covering with rock. 12-9-20 1:32pm Howerton Plumbing is installing approximately 20’ of water line and a valve. 12-10-20 8:46am Howerton are working on moving the fire hydrant and connecting the water line. 2:10pm They have poured the trust blocks and are started backfilling. 12-17-20 8:47am The contractor will be connecting the water and moving the fire hydrant today. The fire hydrant has a leak. Steve Robbins is checking with the Water Department for direction. 12-18-20 Howerton is getting set up to flush the water main. We will start this at approximately 10:30am. 11:27am Howerton has flushed the line free of chlorine. We will pull samples Monday the 21st. 4-1-21 8:44am We will be shutting down the water main at 9am for the tie-in. 9:05am The water is shut off. 10:05am The water has been restored.
Site Visit Partial 04/02/2021
Misc
Informational
03/30/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical.
Site Visit Partial 04/05/2021
Misc
Informational
04/02/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time.
Site Visit Partial 4/9/2021 04/09/2021
Misc
Informational
04/05/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before.
Sanitary Sewer - Air Test Partial 4/14/2021 4/14/2021 04/14/2021
Misc
Informational
04/14/2021

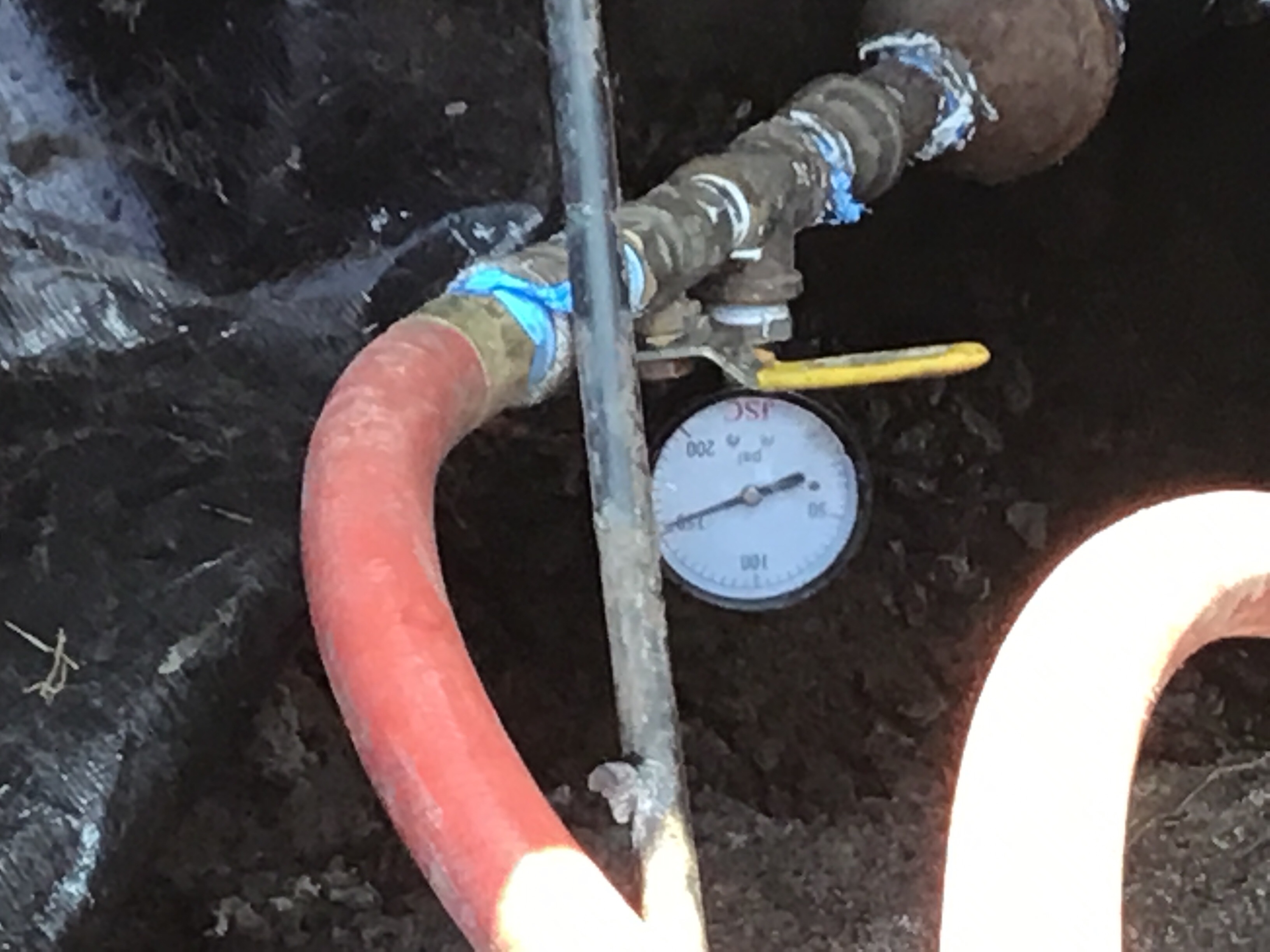

4-14-21 12:13pm testing A5 to A4. The gauge is at 4.0 This section has passed. We are now testing from A-4 to A-3. This section has passed. We are now testing from A-3 to A-2. This section has failed at this time.
Sanitary Sewer - Air Test Partial 04/14/2021
Misc
Informational
04/14/2021
4-14-21 12:13pm testing A5 to A4. The gauge is at 4.0 This section has passed. We are now testing from A-4 to A-3. This section has passed. We are now testing from A-3 to A-2. This section has failed at this time. 3pm They set up from manhole A-2 to A-1. It has passed.
Sanitary Sewer - Vacuum Partial 4/14/2021 4/14/2021 04/14/2021
Misc
Informational
04/14/2021
4-14-21 1:51pm They are setting up to vacuum test manhole A-3. It has passed. 2:09pm They are setting up for manhole A-4. A-4 did not pass. 3:25pm They are setting up for. Manhole A-2. It has failed.
Sanitary Sewer - Mandrel Partial 4/15/2021 4/15/2021 04/15/2021
Misc
Informational
04/15/2021
4-15-21 11:14am We are pulling from A3 to A-4. The mandrel passed through the line but won’t go through the invert. We are now testing from A-5 to A-4. It passed. We pulled from A-3 to A-2. It has passed. We are now pulling from A-2 to A-1. It has passed with a correction needed on the invert of A-2.
Sanitary Sewer - Air Test Passed 4/15/2021 04/15/2021
Misc
Informational
04/14/2021
4-14-21 12:13pm testing A5 to A4. The gauge is at 4.0 This section has passed. We are now testing from A-4 to A-3. This section has passed. We are now testing from A-3 to A-2. This section has failed at this time. 3pm They set up from manhole A-2 to A-1. It has passed. 4-15-21 11:10am We are testing from A-3 to A-2. It has passsed.
Site Visit Partial 4/19/2021 04/19/2021
Misc
Informational
04/09/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time.
Sanitary Sewer - Vacuum Partial 4/22/2021 4/22/2021 04/22/2021
Misc
Informational
04/14/2021
4-14-21 1:51pm They are setting up to vacuum test manhole A-3. It has passed. 2:09pm They are setting up for manhole A-4. A-4 did not pass. 3:25pm They are setting up for. Manhole A-2. It has failed. 4-15-21 11:29am They are setting up to vac test manhole A-2. It has failed. 4-22-21 9:37am They are setting up to do vacuum testing. Manhole A-5 passed with confirmation from Steve Robbins. 3:36pm Manhole A-2 has passed.
Site Visit Partial 4/23/2021 04/23/2021
Misc
Informational
04/19/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today.
Sanitary Sewer - Vacuum Partial 4/26/2021 04/26/2021
Misc
Informational
04/22/2021
4-14-21 1:51pm They are setting up to vacuum test manhole A-3. It has passed. 2:09pm They are setting up for manhole A-4. A-4 did not pass. 3:25pm They are setting up for. Manhole A-2. It has failed. 4-15-21 11:29am They are setting up to vac test manhole A-2. It has failed. 4-22-21 9:37am They are setting up to do vacuum testing. Manhole A-5 passed with confirmation from Steve Robbins. 3:36pm Manhole A-2 has passed. 4-26-21 2:17pm The vac test failed on A-4. They are making corrections and we will try again at 3pm. 3:29pm A-4 has passed
Sanitary Sewer - Vacuum Passed 04/27/2021
Misc
Informational
04/26/2021
4-14-21 1:51pm They are setting up to vacuum test manhole A-3. It has passed. 2:09pm They are setting up for manhole A-4. A-4 did not pass. 3:25pm They are setting up for. Manhole A-2. It has failed. 4-15-21 11:29am They are setting up to vac test manhole A-2. It has failed. 4-22-21 9:37am They are setting up to do vacuum testing. Manhole A-5 passed with confirmation from Steve Robbins. 3:36pm Manhole A-2 has passed. 4-26-21 2:17pm The vac test failed on A-4. They are making corrections and we will try again at 3pm. 3:29pm A-4 has passed
Sanitary Sewer - Mandrel Passed 04/29/2021
Misc
Informational
04/15/2021
4-15-21 11:14am We are pulling from A3 to A-4. The mandrel passed through the line but won’t go through the invert. We are now testing from A-5 to A-4. It passed. We pulled from A-3 to A-2. It has passed. We are now pulling from A-2 to A-1. It has passed with a correction needed on the invert of A-2.
Site Visit Partial 4/30/2021 04/30/2021
Misc
Informational
04/23/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site.
Site Visit Partial 5/3/2021 05/03/2021
Misc
Informational
04/30/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time.
Site Visit Partial 5/4/2021 05/04/2021
Misc
Informational
05/03/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site.
Site Visit Partial 5/5/2021 05/05/2021
Misc
Informational
05/04/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today.
Site Visit Partial 5/6/2021 05/06/2021
Misc
Informational
05/05/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time.
Site Visit Partial 05/10/2021
Misc
Informational
05/06/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles.
Site Visit Partial 5/11/2021 05/11/2021
Misc
Informational
05/10/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test.
Site Visit Partial 5/12/2021 5/12/2021 05/12/2021
Misc
Informational
05/11/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site.
Site Visit Partial 5/14/2021 05/14/2021
Misc
Informational
05/12/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees.
Site Visit Partial 05/24/2021
Misc
Informational
05/14/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today.
Site Visit Partial 05/25/2021
Misc
Informational
05/24/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested.
Erosion Control Inspection Partial 5/26/2021 5/26/2021 05/26/2021
Misc
Informational
03/23/2021
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time. 3-16-21 9:04am There is a section of silt fence down but it is not causing any issues. 3-18-21 2:12pm There is silt fence down but it is not effecting erosion controls at this time. 3-23-21 2:26pm It is raining and erosion controls are working at this time. The street is clean. 5-26-21 10:17am The erosion controls are in place and working. The road is clean.
Site Visit Partial 5/26/2021 5/26/2021 05/26/2021
Misc
Informational
05/25/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time.
Site Visit Partial 6/1/2021 06/01/2021
Misc
Informational
05/26/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time.
Site Visit Partial 6/2/2021 6/2/2021 06/02/2021
Misc
Informational
06/01/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time.
Site Visit Partial 6/7/2021 06/07/2021
Misc
Informational
06/02/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time.
Site Visit Partial 6/8/2021 06/08/2021
Misc
Informational
06/07/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place.
Site Visit Partial 06/14/2021
Misc
Informational
06/08/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road.
Site Visit Partial 6/15/2021 06/15/2021
Misc
Informational
06/14/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place.
Site Visit Partial 06/21/2021
Misc
Informational
06/15/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time.
Site Visit Partial 6/22/2021 06/22/2021
Misc
Informational
06/21/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site.
Site Visit Partial 7/1/2021 7/1/2021 07/01/2021
Misc
Informational
06/22/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place.
Erosion Control Inspection Partial 07/02/2021
Misc
Informational
05/26/2021
11-23-20 1:25PM light rain and sleet. All erosion controls are in place and working at this time. 11-25-20 9:02am All of the erosion controls are in place and working at this time. 3-16-21 9:04am There is a section of silt fence down but it is not causing any issues. 3-18-21 2:12pm There is silt fence down but it is not effecting erosion controls at this time. 3-23-21 2:26pm It is raining and erosion controls are working at this time. The street is clean. 5-26-21 10:17am The erosion controls are in place and working. The road is clean. 7-2-21 9:35am The erosion controls are in place and working at this time.
Site Visit Partial 7/20/2021 07/20/2021
Misc
Informational
07/01/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line.
Site Visit Partial 7/26/2021 07/26/2021
Misc
Informational
07/20/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line. 7-26-21 1:01pm There is no work taking place on site.
Site Visit Partial 08/05/2021
Misc
Informational
07/26/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line. 7-26-21 1:01pm There is no work taking place on site. 8-5-21 11am There is no work on site. The sanitary line has passed.
Site Visit Partial 8/10/2021 08/10/2021
Misc
Informational
08/05/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line. 7-26-21 1:01pm There is no work taking place on site. 8-5-21 11am There is no work on site. The sanitary line has passed. 8-10-21 9:35am rain. there is no work taking place. 12-16-21 Thursday Contractor began working on subgrade stabilization. 12-20-21 Monday No work by contractor, but Goggle Fiber was relocating utilities so contractor could continued construction on project. 01/11/22 Tuesday No work at site since the end of last year. 02/04/22 Friday No work onsite, still waiting for contractor to get in contact about the deviation basin. 02/07/22 Monday No work onsite. Communication and fiber companies continued installation of cables and underground wires for relocated pole. The relocated of pole for the installation of sidewalks. 02/08/22 Tuesday No work onsite by my contractor. Gas companies were locating existing lines to align with the gas lines to be installed. 02/09/22 Wednesday No work onsite by City contractors. Gas company contractor Miller Pipeline working along NW Olive Street. I informed Miller’s onsite supervisor that they needed to ensure the streets were clean before the end of the work day. Their work did not prohibit the regular flow of traffic. 02/11/22 Friday No work onsite by City contractors, but Gas companies Miller & Spire are working around and onsite installing new gas update gas main. 02/23/22 Wednesday No work onsite by City contractors, but Miller Pipeline Co. Is still work to install new main in the area. 02/24/22 Thursday No work. 03/03/22 Thursday No work. 03/09/22 Wednesday ( Wil Pav) Contractor located the manhole lids for the sanitary lids in the street. 03/30/22 Wednesday No work. 04/12/22 Tuesday (Developer- Dick Burton) Inspection of site finds that the RCP storm pipe that is to be repaired has filled up with leaves. The functionality of the pipe is in question. Also the Developer was grading site to building up grading level around Cul-Da-Sac. Hydrant at the cul-da-sac needs to be raise to proper grade.

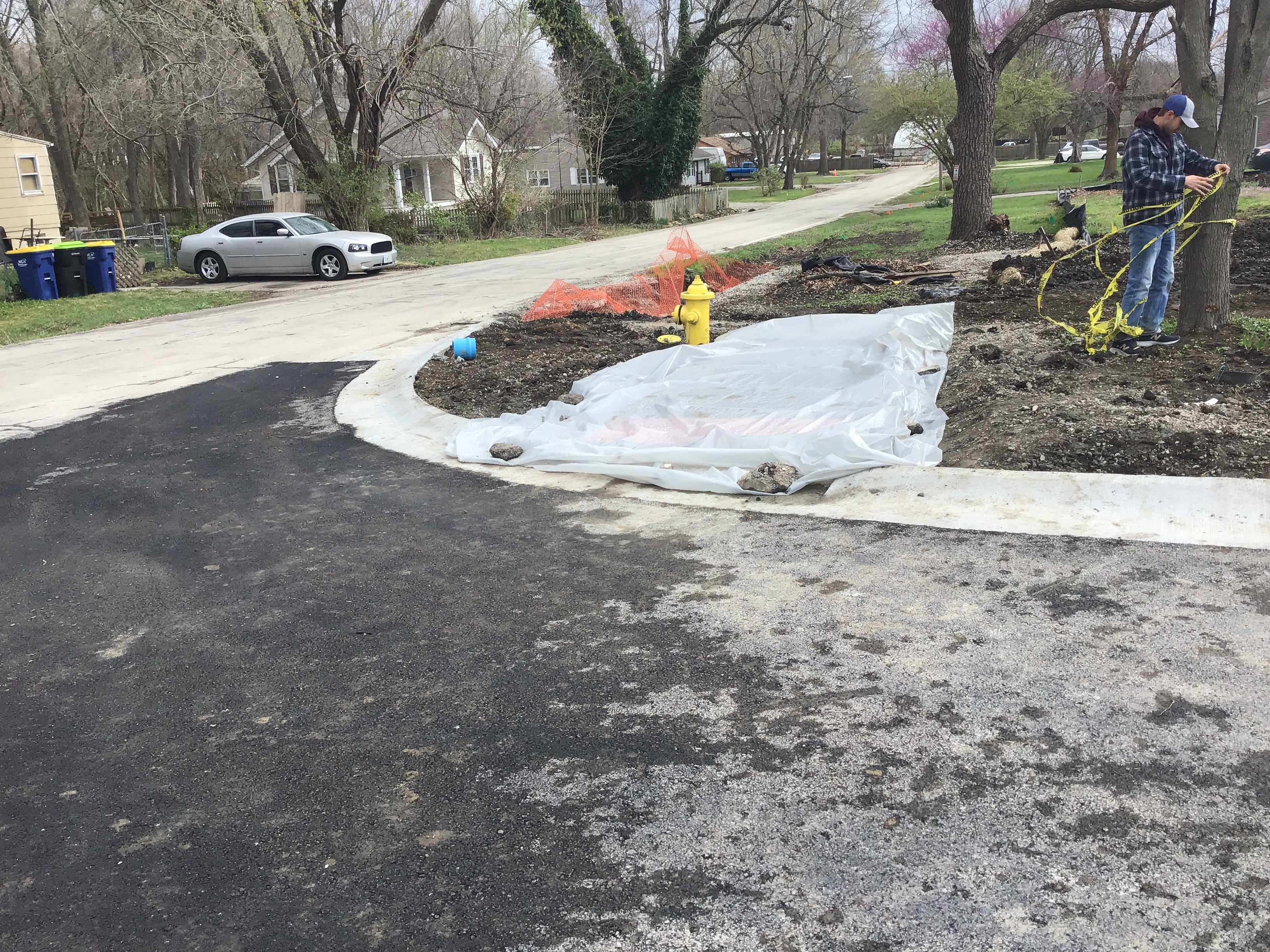

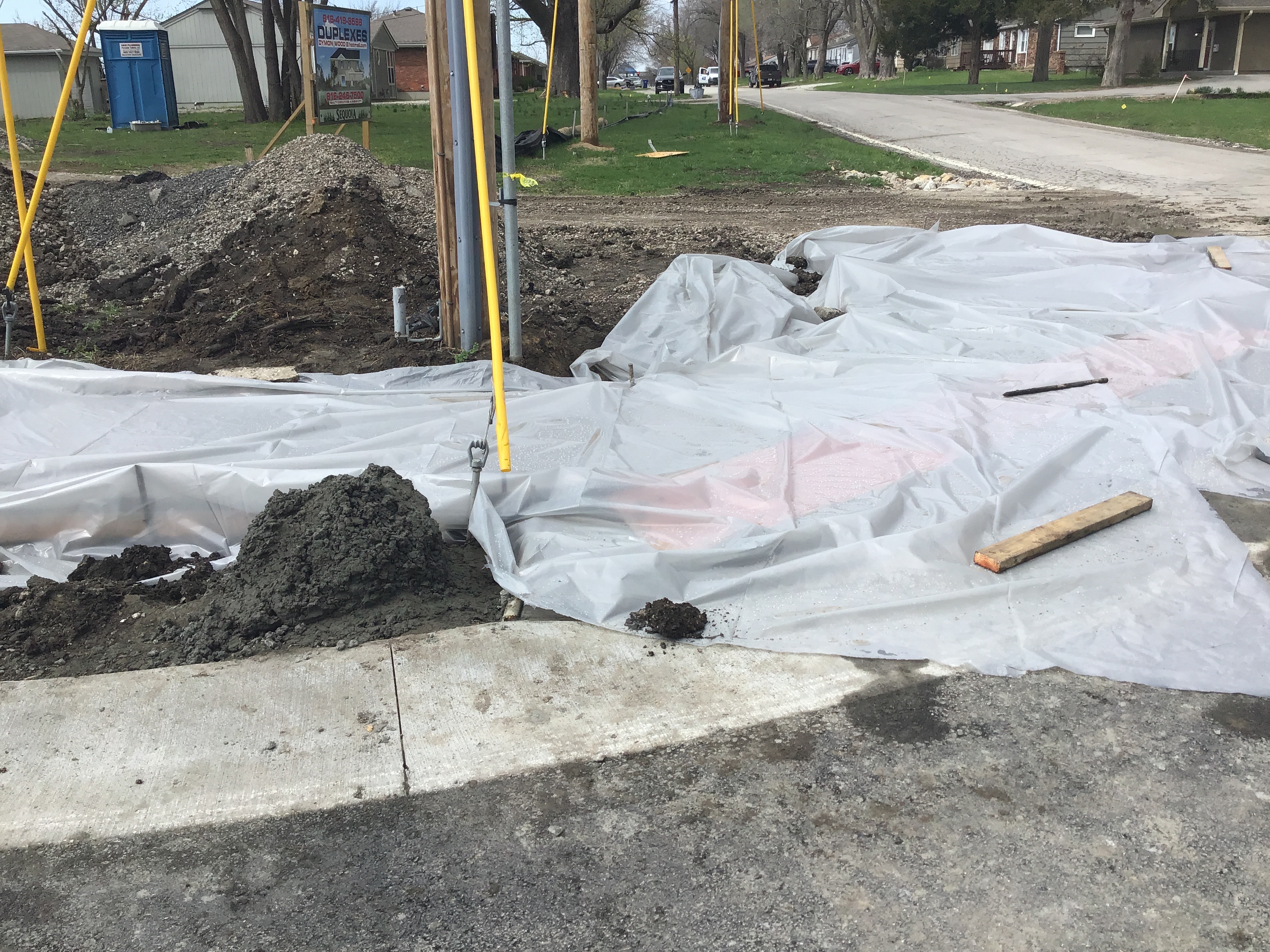

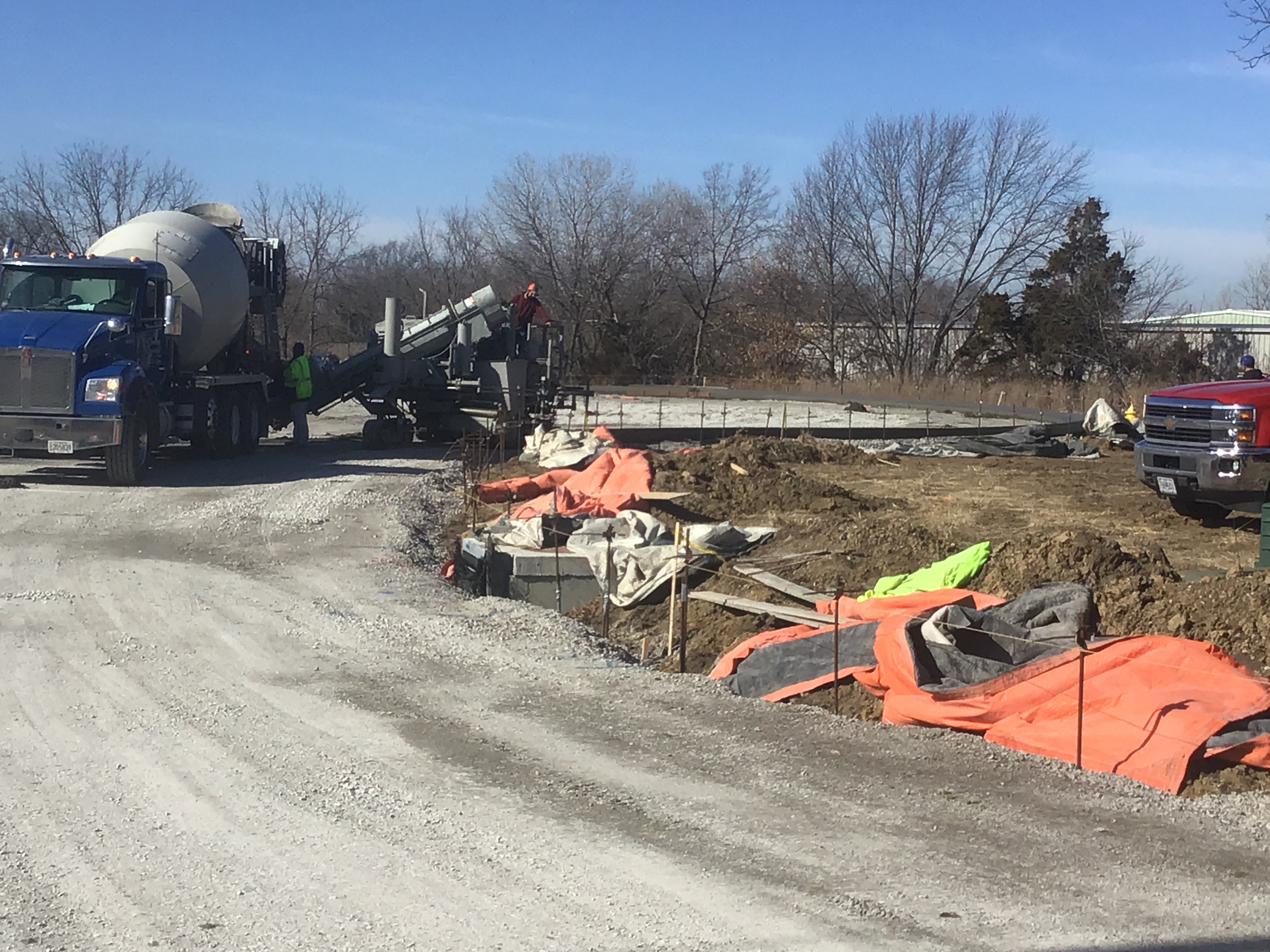

Pavement-Stabilized Subgrade Partial 12/17/2021
Misc
Informational
12/17/2021

12/17/21 Friday (Will.Pav) Contractor continue to stabilization of subgrade as-per plan using Rural 5.
Pavement-Stabilized Subgrade Partial 12/29/2021
Misc
Informational
12/29/2021
12/29/21 Wednesday (Wil-Pav) Contractor continued to grade and stake subgrade to prepare for construction of street on project.

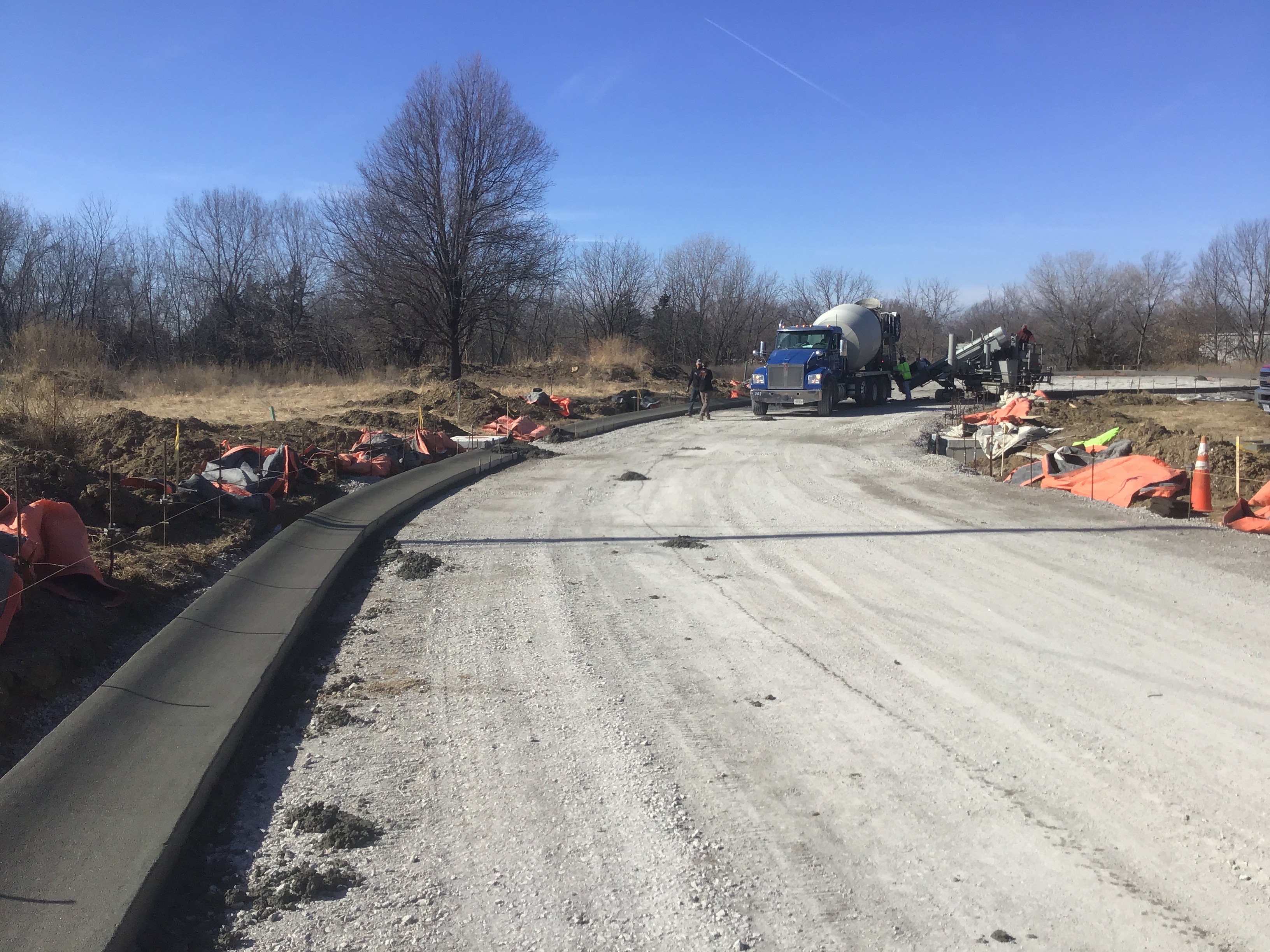

Curb - Proof Roll Passed 01/31/2022
Misc
Informational
01/31/2022
Curbs proof roll passed we also proof rolled the street.
Pavement-Proof Roll Passed 01/31/2022
Misc
Informational
01/31/2022
Pavement proof roll passed test.
Pavement-Curb Construction Partial 01/31/2022
Misc
Informational
01/31/2022

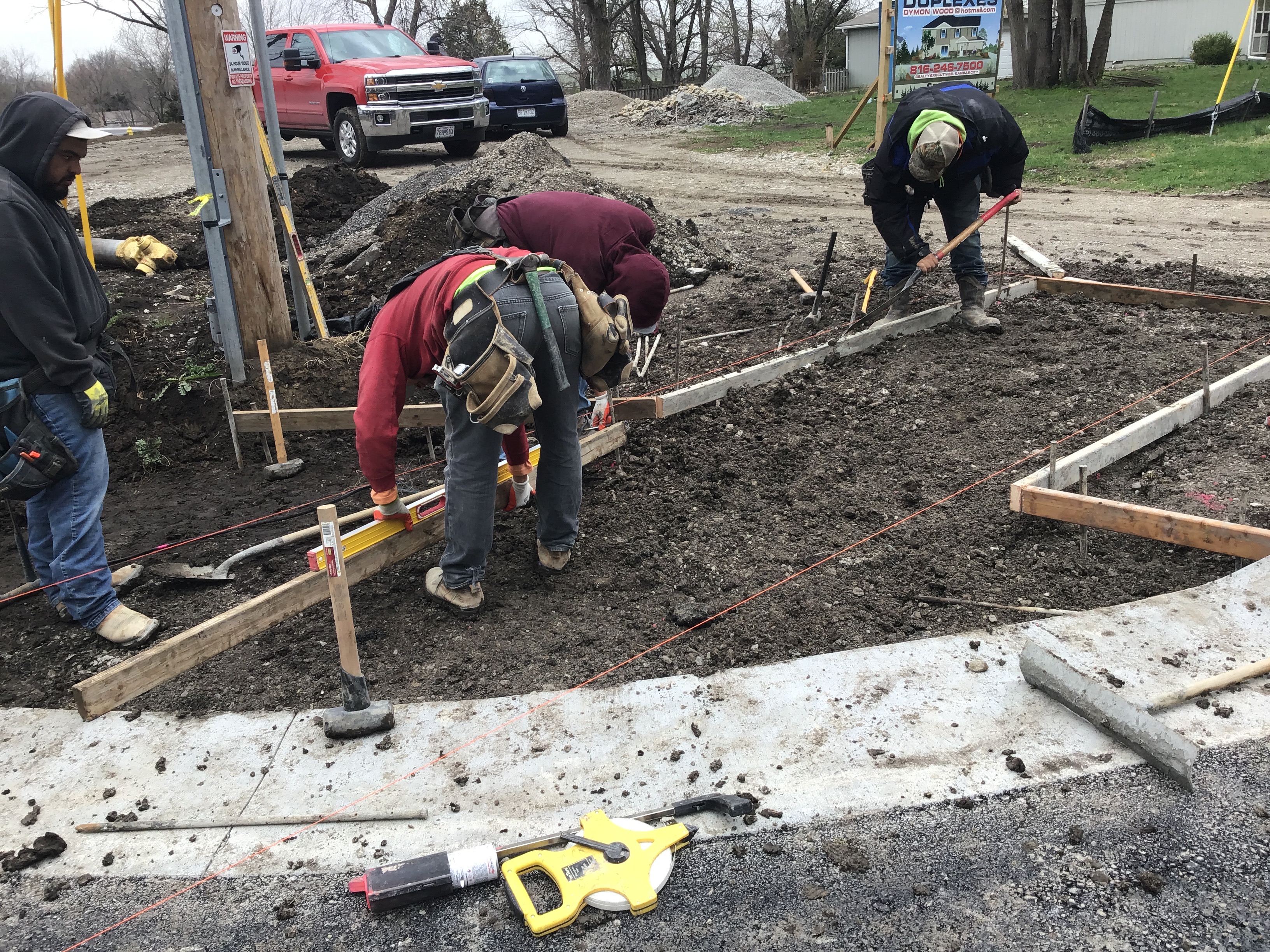

1/31/22 Will-Pav Began installation of curbs around 12:00PM. Approximately 675’ of curbs was installed, and covered with blankets. 02/01/22 WIL-Pav Contractor installed approximately 70’ additional feet of circumference curb and storm curb for storm inlet. All curbs were covered with blankets.
Erosion Control Inspection Partial 03/23/2022
Misc
Informational
03/18/2022
03/18/22 Erosion control is still functioning. 03/23/22 Wednesday .Erosion control measure and devices are operable
Misc
Informational
10/03/2023
10/03/23 Tuesday JMJ (Mr, Dick Burton) Contractor has periodic cut grass and keep up with erosion at times during the long absent from project site. All erosion control measure and devices appear to be operable.
Pavement-Aggregate Base Partial 04/01/2022
Misc
Informational
04/01/2022
04/01/22 Friday Contractor plans weather permitting to lay aggregate base. Contractor completed laying the base asphalt, weather conditions began cool so surface cannot be done today.
Pavement-Surface Passed 04/11/2022
Misc
Informational
04/11/2022
04/11/22 Wil-Pav Contractor laid surface pavement type 5 Virgin asphalt. Last truck came before !1:00AM.

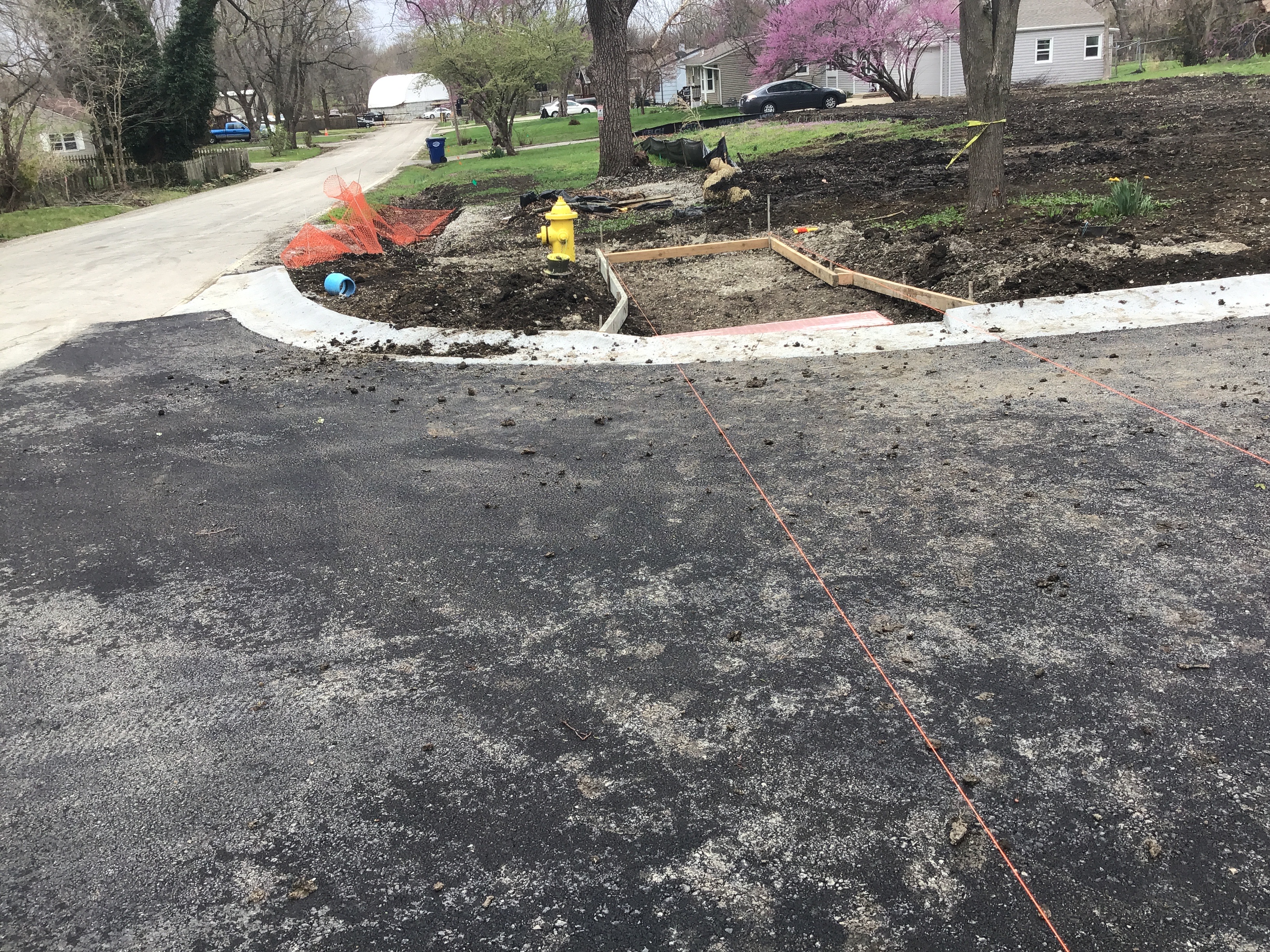

Sidewalk Inspection Partial 04/13/2022
Misc
Informational
04/13/2022
04/13/22 Wednesday Contractor has begun to set forms for sidewalks and ADA at the entrance of project. Forms and material should be ready for inspection after 10:30AM today. Contractor finished the ADA ramps & sidewalks and covered it up because of the inclement weather rain & flurries .
Grading/Excavation/Fill Inspection Partial 06/27/2022
Misc
Informational
06/27/2022
06/27/22 Monday Contractor began bringing in soil for grading as per project plans. ( I have reinforced and re-informed (numerous times) the developer that he will not be able to go vertical until as-built are submitted and approved for underground utilities and basin.) 06/28/22 Tuesday Contractor continued importing soil to grade site to proposed grade. 06/29/22 Wednesday Continued grading. 07/01/22 Friday Contractor continued haul in soil and grade site per project plans. Work was also performed yesterday.
Grading/Excavation/Fill Inspection Partial 09/19/2022
Misc
Informational
06/27/2022
06/27/22 Monday Contractor began bringing in soil for grading as per project plans. ( I have reinforced and re-informed (numerous times) the developer that he will not be able to go vertical until as-built are submitted and approved for underground utilities and basin.)
Misc
Informational
09/19/2022
09/19/22 Monday JMJ Contractor has started back to work on site, but did not contact inspector. I will try to contact the works on the site to reestablish contact. It appears that the contractor is building a retain wall. Retaining Blocks where on site. I talked to developer ( Dick Burton ) about The City of Lee’s Summit expectations of him. I strong suggested he get a third party inspector. Contractor installed approximately 90’ of 8’ tall retaining wall on the Westside. Contractor continued to build retain wall heading towards the East.
Retaining Wall Inspection Partial 09/21/2022
Misc
Informational
09/21/2022
09/21/22 Wednesday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installing retaining wall 8’ high and 60’ wide during this week. Retaining wall was headed Eastbound on the North portion of project. Geogrid was installed to stabilize retaining wall foundation.
Retaining Wall Inspection Partial 10/13/2022
Misc
Informational
09/21/2022
09/21/22 Wednesday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installing retaining wall 8’ high and 60’ wide during this week. Retaining wall was headed Eastbound on the North portion of project. Geogrid was installed to stabilize retaining wall foundation. 10/13/22 Thursday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued to installation of retention wall. Contractor has been at site off and on for the past month.
Retaining Wall Inspection Partial 10/21/2022
Misc
Informational
10/13/2022
09/21/22 Wednesday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installing retaining wall 8’ high and 60’ wide during this week. Retaining wall was headed Eastbound on the North portion of project. Geogrid was installed to stabilize retaining wall foundation. 10/13/22 Thursday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued to installation of retention wall. Contractor has been at site off and on for the past month. 10/21/22 Friday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installation of retaining wall and Geogrid as step-up.
Retaining Wall Inspection Partial 10/26/2022
Misc
Informational
10/21/2022
09/21/22 Wednesday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installing retaining wall 8’ high and 60’ wide during this week. Retaining wall was headed Eastbound on the North portion of project. Geogrid was installed to stabilize retaining wall foundation. 10/13/22 Thursday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued to installation of retaining wall. Contractor has been at site off and on for the past month. 10/21/22 Friday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installation of retaining wall and Geogrid as step-up. 10/26/22 Wednesday JMJ ( Dick Burton Perpetual Water LLC ) Contractor continued installed retaining but no work was being performed @ 10:00AM today.
Water Line - Coliform Test 1 Partial 11/16/2022
Misc
Informational
11/16/2022
11/16/22 Wednesday JMJ ( Howerton Plumbing ) Taking sample from end of line. Contractor had to retake sample because a water valve to project was discovered closed when should have been open. Water line was throughly flushed before first sample was taken.
Water Line - Coliform Test 2 Partial 11/17/2022
Misc
Informational
11/17/2022
11/17/22 Wednesday JMJ ( Howerton Plumbing ) Collected the second required water sample. After two consecutive passing samples water valve can remain open and installed water lines for project can be part of the Lee’s Summit public water system.
Detention Basin Partial 8/11/2023 8/11/2023 08/11/2023
Misc
Informational
11/17/2020

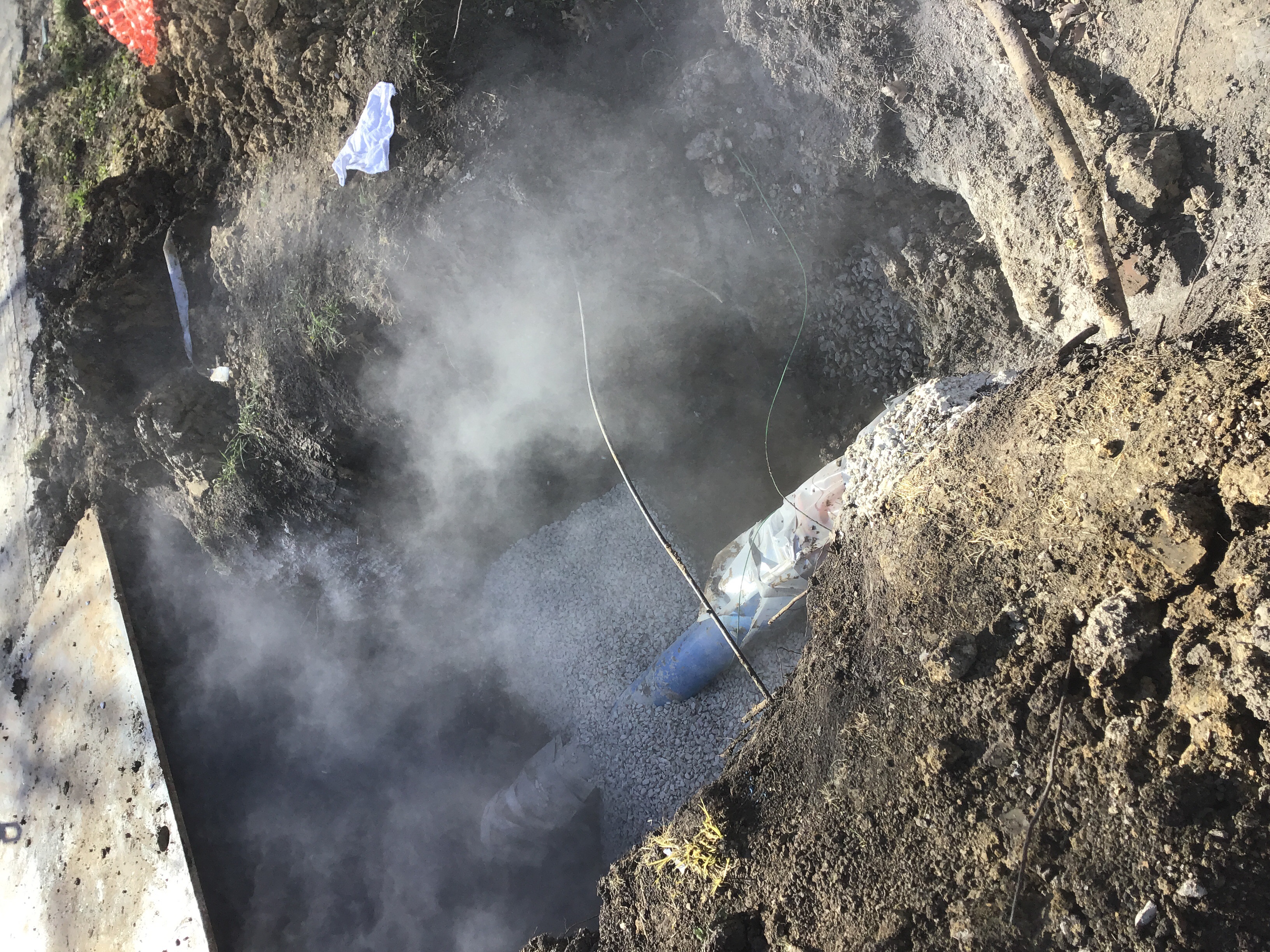

11-17-20 2:05pm They are installing the storm pipe on the West side of the pipe. They have rip rap installed. They are making changes and will have the engineer turn in as-builds. 08/11/23 Friday JMJ (Mr. Dick Burton) Contractor was working on installing rip-rap around inlet and outlet pipes for the basin. Note: No stabilizing mat to hold rip-rap in place, appears that rip-rap is @ the same elevation or higher than elevation of inlets and outlets storm pipe, slit fence and/or other stabilizing methods need to be employed to prevent silting. Train session was held onsite of project consensus inspector in attend agree that construction practices were questionable. There was improvement in size of rip-rap from 1/2" to 4" to 6". I have copied the city Field Engineer for Dev., Assistant Director of Dev. Field Operation, and my manager pictures of rip-rap around inlet & outlet storm pipe. 10/03/23 Tuesday JMJ (Mr. Dick Burton) Contractor has begun the process of installing mats, geogrid, correct rip-rap for detention basin. Contractor has email pictures of correction process for install of rip-rap.
Site Visit Partial 08/24/2023
Misc
Informational
08/10/2021
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line. 7-26-21 1:01pm There is no work taking place on site. 8-5-21 11am There is no work on site. The sanitary line has passed. 8-10-21 9:35am rain. there is no work taking place. 8-24-23 11:14 a.m A.A there is no work taking place at this time
Site Visit Partial 12/5/2023 12/5/2023 12/05/2023
Misc
Informational
08/24/2023
11-11-20 2:06pm I spoke with Justin about installing water and sanitary line. He wants to do the water tie in next week. 11-16-20 11:41am I checked on a concern from a citizen about the asphalt. All asphalt damage is pre-existing. 11-23-20 9:02am There is no work taking place at this time. 11-24-20 8:02am There is no work on site today. 11-30-20 9:04am Howerton Plumbing is on site to dig for the water line past a power pole. 12-4-20 12:05pm I am meeting Steve Robbins and Kent Moter on site to look at the detention basin. The contractor made changes without a re-submital. 12-7-20 9:23am They are on site laying out materials. They will not need any inspections today. 12-8-20 9:01am There is no activity on this site at this time. 12-9-20 9:56am Renaissance Ifrastructure Consulting is on site taking shots. No othe work is taking place. 12-11-20 7:32am There is no work on site due to weather. 12-14-20 7:48am There is no work taking place at this time. 12-14-20 1:45pm I met with Justin on site to discuss setting up a time for the hydrostatic test for the water line. We will test on 12-15-20 at 10:30am. 12-15-20 The equipment has failed so they will try again tomorrow. 12-16-20 10:47AM Howerton Plumbing are setting up for a hydrostatic test later today. 12-28-20 9:30am Howerton is on site to work on sanitary. 12-31-20 10:51AM There is no work one site today. 1-5-21 7:57am There is no work taking place at this time due to weather. 1-11-21 9:30am There is no work on site at this time. 1-25-21 7:56am Raining. There is no work taking place. 1-26-21 7:34am There is no work on site at this time. The ground is frozen with light snow. 1-29-21 1:48pm There is no work taking place on site. 2-1-21 7:34am No work is taking place at this time. 2-3-21 10:52am They have AB3 being delivered and are prepping the site for backfilling. 2-8-21 9:43am Snow. There is no work due to weather. 2-9-21 7:24am Snow. There is no work on site today due to weather. There are no erosion control issues. 2-10-21 9:03am There is no work taking place. 2-18-21 8:02am There is no work taking place due to weather. The site is covered in snow. 2-22-21 7:46am No work taking place. 2-23-21 9:22am There is no work taking place today. 2-24-21 7:22am There is no work taking place at this time. The silt fence is down but not causing any issues. 3-1-21 3:33pm There is no work taking place on site. 3-3-21 7:23am They worked on 3-2 backfillling. There is no work taking place today. The site is picked up and the street is clean., 3-4-21 8:15am There no work taking place and the site is clean. The roads are clean. 3-5-21 7:59am No work taking place. The site is clean. 3-8-21 3-8-21 9:34am Howerton is on site backfilling the sanitary main. 3-10-21 8:27am There is no work taking place on site at this time. 3-12-21 11:10am Rain. No work taking place. The roads leading into the site are clean. 3-15-21 9am The site is wet and muddy. There is no work on site. 3-22-21 8:52am Storm pipe has been delivered to the site and they are starting on repairing some silt fence. 3-26-21 8:25am There is no work on site. The street is clean., 3-29-021 12:50pm Howerton called and needed to discuss the storm pipe line D. I came on site and reviewed the plans with them. I will be going to CH to ask Enginering questions. 3-30-21 8:38am I met with water on site to locate valves and to inspect the tee on the main. We will be shutting off water on 4-1-21 to tie in to the main. Howerton is putting out door hangers now. 4-2-21 10:48am Howerton is digging out to place conduit for electrical. 4-5-21 8:32am Howerton is cleaning up debris on the site. There are no inspections needed at this time. 4-9-21 9:07am There is no work on site. The site is wet from rain the day before. 4-19-21 9:57am There is no work being done on site at this time. 4-23-21 11:13am There is no work taking place today. 4-30-21 9:02am There is no work on site. 5-3-21 8:58am No work on site at this time. 5-4-21 8:49am Light rain. There is no work taking place on site. 5-5-21 11:05am There is no work on site today. 5-6-21 10:41am There is no work taking place at this time. 5-10-21 10:04am Evergy is on site setting poles. 5-11-21 3:44pm Howerton was on site to work on jetting the sanitary line for the camera test. 5-12-21 10:30am There was no work taking place on site. 5-14-21 11:15am Howerton is on site cleaning up trees. 5-24-21 8:57am There is no work taking place on site. I have called the contractor and met him on site to discuss the corrections that need made on the sanitary line that has been installed. He is starting the repairs today. 5-25-21 9:02am Howerton has dug up the sanitary line for a sag. They have backfilled and we will check it in 30 days. They have made all other correction that the Water Department requested. 5-26-21 10:20am There is no work taking place at this time. 6-1-21 8:59am There is no work taking place at this time. 6-2-21 8:54am There is no work on site at this time. 6-7-21 11:30am There is no work taking place at this time. 6-8-21 9:30am There is no work taking place. 6-14-21 10:56am There is no work taking place at this time. The site is clean and there is no debris on the road. 6-15-21 3:43pm There is no work taking place. 6-21-21 11:21am There is no work needing inspections at this time. 6-22-21 10:53am There is no work taking place on site. 7-1-21 11:43am There is no work taking place. 7-20-21 1:56pm There is no work taking place. I have not herd from the water department regarding the re-inspection of the sanitary line. 7-26-21 1:01pm There is no work taking place on site. 8-5-21 11am There is no work on site. The sanitary line has passed. 8-10-21 9:35am rain. there is no work taking place. 8-24-23 11:14 a.m A.A there is no work taking place at this time 8-25-23 A.A No work taking place 8-28-23 A.A no work taking place 12/05/23 JMJ Contractor has not installed any street sign that are required to move toward final acceptance of project.
Documents & Images
Date Uploaded File Type Document Name
11/11/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
12/04/2020 Letter INSPECTION SUMMARY
12/08/2020 Approved Plans Sequoia Revised Street, Storm, Sanitary and Water Plans Approved 12.8.20
11/23/2020 Letter INSPECTION SUMMARY
12/15/2020 Approved Plans Sequoia Residential Revised Sanitary Approved 12.15.20
11/23/2020 Letter INSPECTION SUMMARY
11/23/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/04/2020 Letter DE-Permit
12/21/2020 Letter INSPECTION SUMMARY
11/04/2020 Approved Plans Sequoia Residential Street, Storm, Sanitary and Water Approved 11.4.20
10/29/2020 Receipt Receipt for transaction: 2020-007269
12/11/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/28/2020 Letter INSPECTION SUMMARY
12/28/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/08/2020 Letter INSPECTION SUMMARY
12/28/2020 Letter INSPECTION SUMMARY
12/07/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
11/25/2020 Letter INSPECTION SUMMARY
01/11/2021 Letter INSPECTION SUMMARY
11/24/2020 Letter INSPECTION SUMMARY
12/15/2020 Letter INSPECTION SUMMARY
12/14/2020 Letter INSPECTION SUMMARY
12/14/2020 Letter INSPECTION SUMMARY
01/19/2021 Letter INSPECTION SUMMARY
01/20/2021 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/16/2020 Pressure gauge hydrostatic .jpg
12/16/2020 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/23/2020 Letter INSPECTION SUMMARY
12/23/2020 Letter INSPECTION SUMMARY
12/28/2020 Letter INSPECTION SUMMARY
12/28/2020 Sanitary line out of A2.jpg
12/28/2020 Trench check.jpg
02/18/2021 Letter INSPECTION SUMMARY
12/29/2020 Letter INSPECTION SUMMARY
12/31/2020 Letter INSPECTION SUMMARY
02/25/2021 Letter INSPECTION SUMMARY
12/18/2020 Sanitary line.jpg
12/18/2020 Letter INSPECTION SUMMARY
12/18/2020 Letter INSPECTION SUMMARY

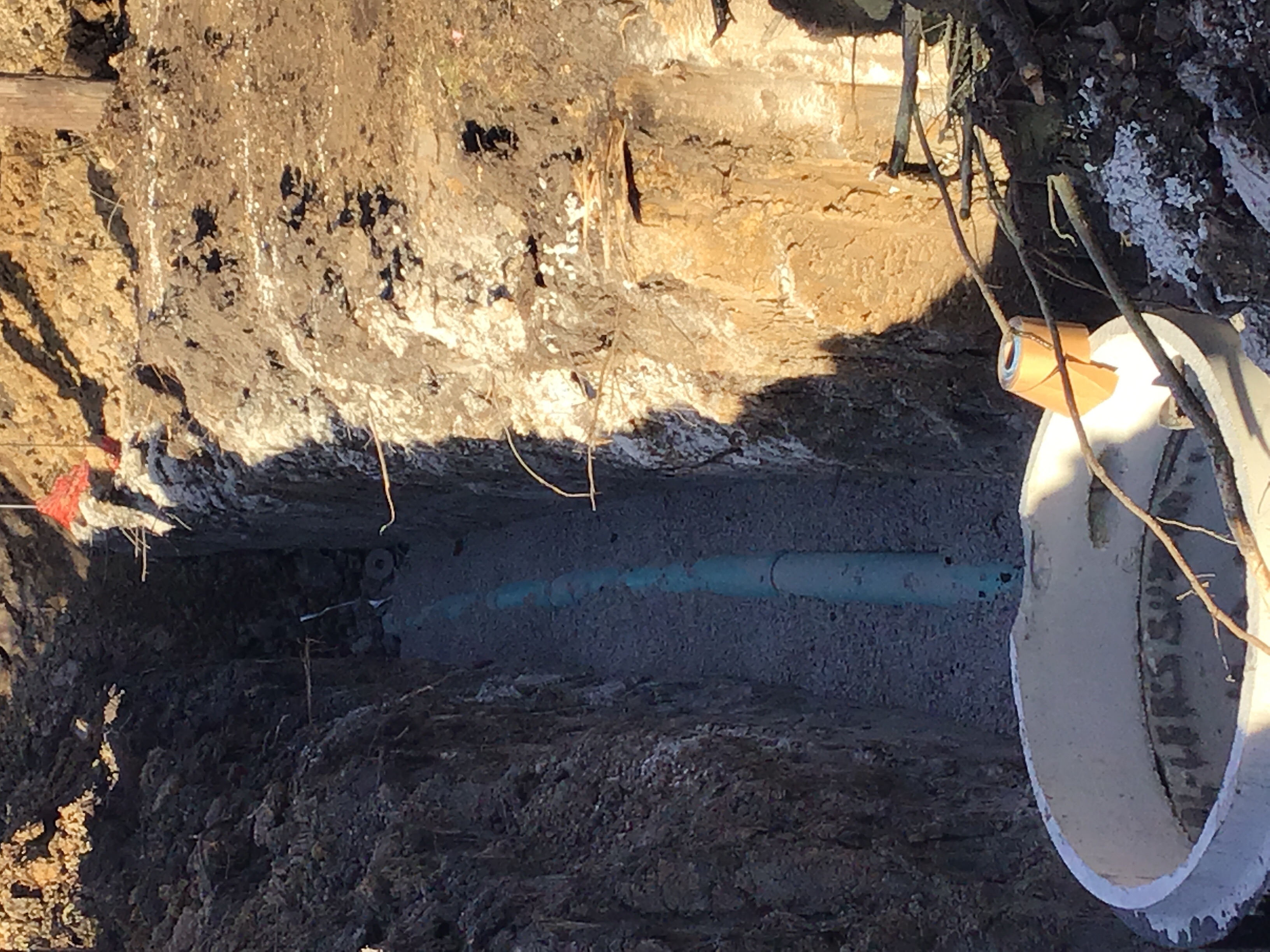

12/21/2020 Sanitary line.jpg0
12/21/2020 Letter INSPECTION SUMMARY
12/22/2020 Letter INSPECTION SUMMARY
01/14/2021 Sanitary .jpg
01/14/2021 Letter INSPECTION SUMMARY
03/10/2021 Letter INSPECTION SUMMARY
01/21/2021 Letter INSPECTION SUMMARY
03/15/2021 Letter INSPECTION SUMMARY
01/05/2021 Letter INSPECTION SUMMARY
01/12/2021 Letter INSPECTION SUMMARY
01/13/2021 Letter INSPECTION SUMMARY
03/23/2021 Letter INSPECTION SUMMARY
01/25/2021 Letter INSPECTION SUMMARY
03/29/2021 Letter INSPECTION SUMMARY
03/29/2021 Letter INSPECTION SUMMARY
01/26/2021 Letter INSPECTION SUMMARY
02/01/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
03/31/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
02/08/2021 Letter INSPECTION SUMMARY
02/09/2021 Letter INSPECTION SUMMARY
02/10/2021 Letter INSPECTION SUMMARY
02/22/2021 Letter INSPECTION SUMMARY
02/24/2021 Letter INSPECTION SUMMARY
03/01/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
04/09/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/05/2021 Letter INSPECTION SUMMARY
03/09/2021 Letter INSPECTION SUMMARY
03/03/2021 Letter INSPECTION SUMMARY
03/04/2021 Letter INSPECTION SUMMARY
04/26/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
03/12/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY
04/01/2021 Water tie-in 2.jpg
04/01/2021 Water tie-in 3.jpg
05/06/2021 sequoia sample 1
05/06/2021 Sequoia sample 2

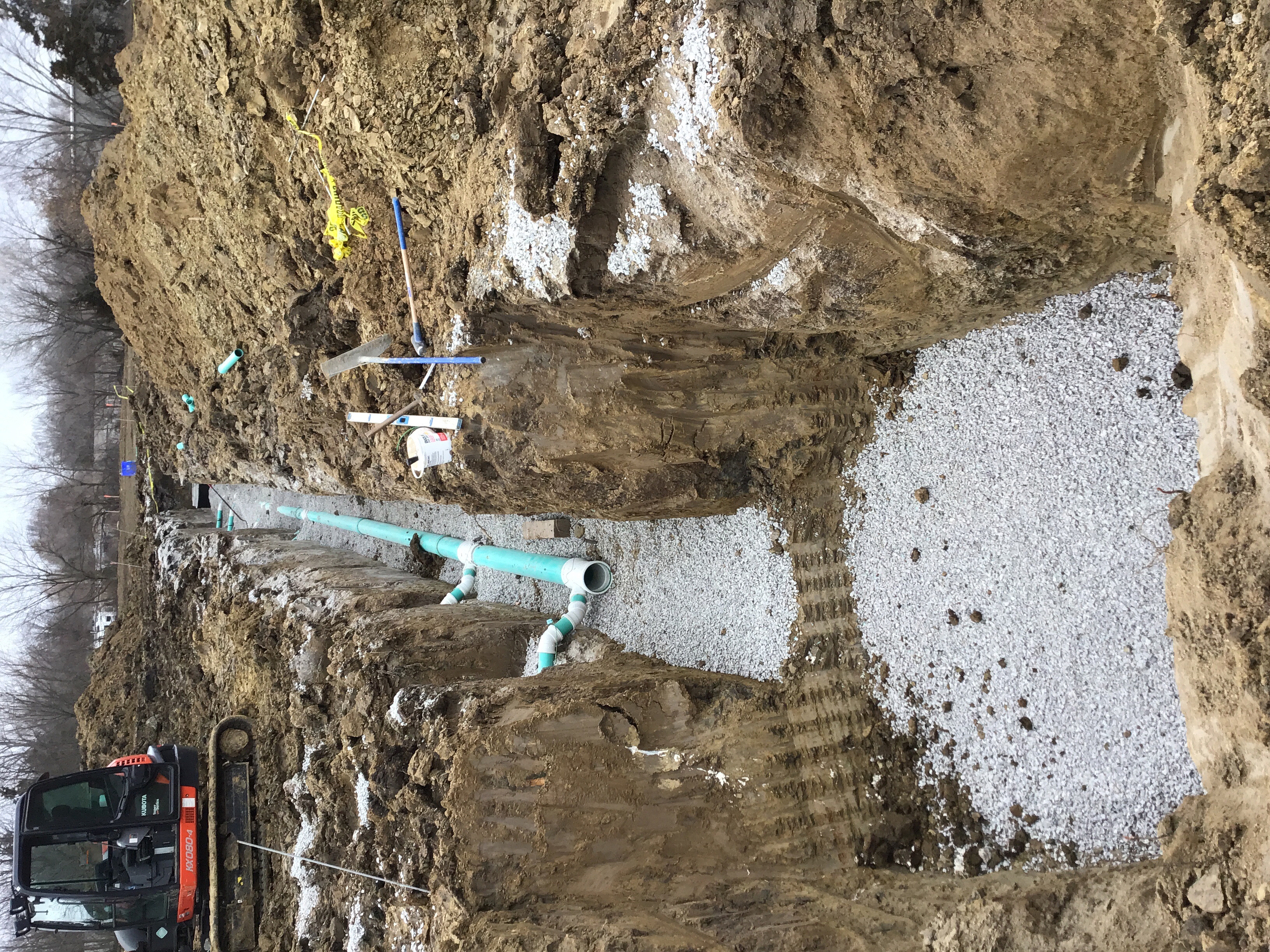

04/01/2021 Water line.jpg
04/01/2021 Water line with rock.jpg
05/11/2021 Letter INSPECTION SUMMARY
04/01/2021 Letter INSPECTION SUMMARY
04/02/2021 Letter INSPECTION SUMMARY
05/24/2021 Letter INSPECTION SUMMARY
04/05/2021 Letter INSPECTION SUMMARY
03/18/2021 Letter INSPECTION SUMMARY
03/19/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/29/2021 Letter INSPECTION SUMMARY
03/30/2021 Letter INSPECTION SUMMARY
06/08/2021 Letter INSPECTION SUMMARY
03/30/2021 Letter INSPECTION SUMMARY

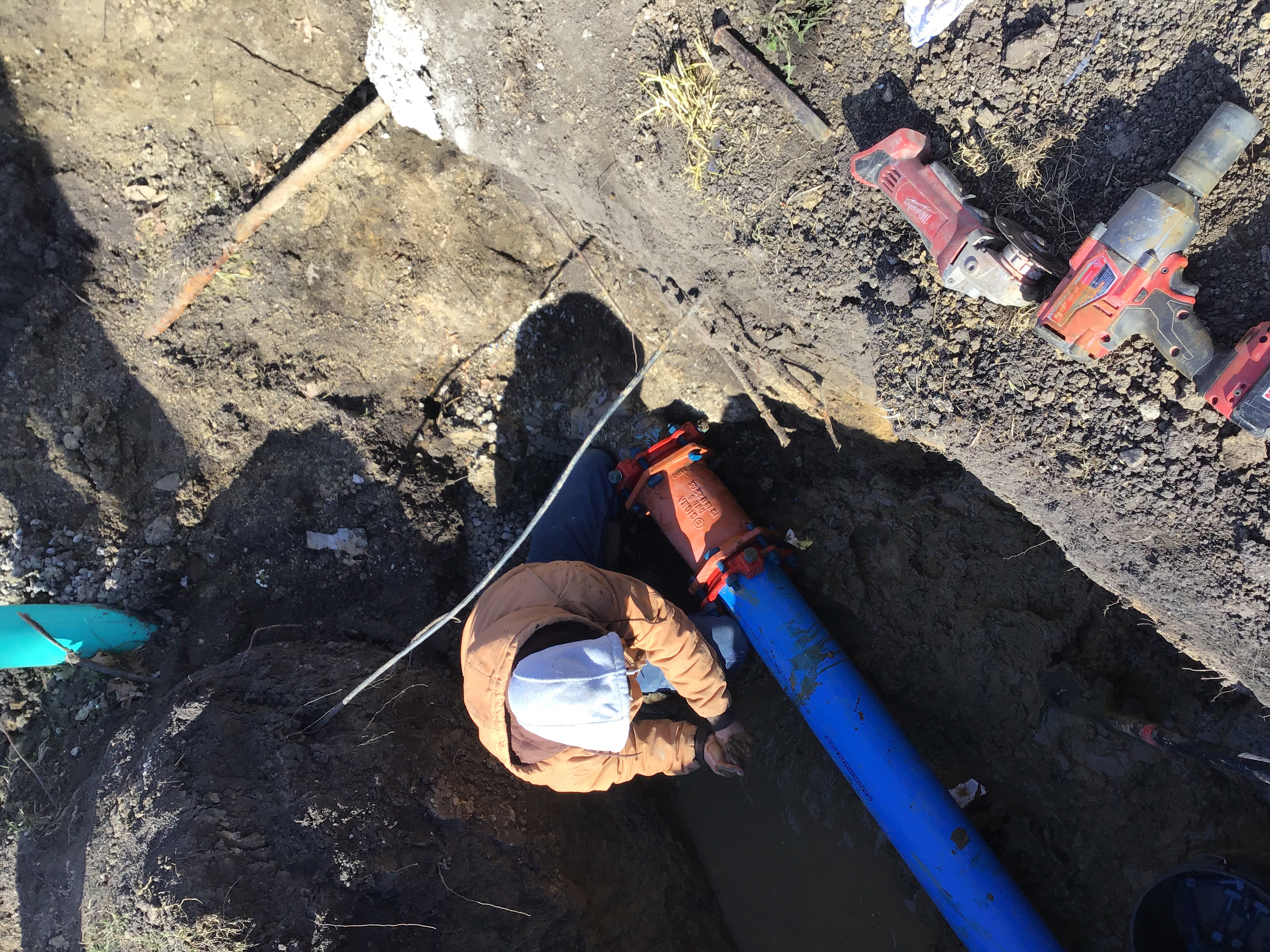

04/01/2021 Water tie-in.jpg
06/21/2021 Letter INSPECTION SUMMARY
04/22/2021 Letter INSPECTION SUMMARY
05/03/2021 Letter INSPECTION SUMMARY
05/04/2021 Letter INSPECTION SUMMARY
05/05/2021 Letter INSPECTION SUMMARY
07/26/2021 Letter INSPECTION SUMMARY
08/05/2021 Letter INSPECTION SUMMARY
05/06/2021 Letter INSPECTION SUMMARY
11/08/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
11/10/2021 Letter INSPECTION SUMMARY
05/10/2021 Letter INSPECTION SUMMARY
12/16/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/23/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/27/2021 Letter INSPECTION SUMMARY
04/19/2021 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 image.jpg0
01/31/2022 image.jpg1
01/31/2022 image.jpg2
01/31/2022 Letter INSPECTION SUMMARY
04/29/2021 Letter INSPECTION SUMMARY
04/30/2021 Letter INSPECTION SUMMARY
05/12/2021 Letter INSPECTION SUMMARY
03/18/2022 Letter INSPECTION SUMMARY
05/14/2021 Letter INSPECTION SUMMARY
05/25/2021 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
06/01/2021 Letter INSPECTION SUMMARY
06/02/2021 Letter INSPECTION SUMMARY
06/07/2021 Letter INSPECTION SUMMARY
06/14/2021 Letter INSPECTION SUMMARY
07/01/2021 Letter INSPECTION SUMMARY
07/02/2021 Letter INSPECTION SUMMARY
07/20/2021 Letter INSPECTION SUMMARY
08/10/2021 Letter INSPECTION SUMMARY
06/27/2022 Letter INSPECTION SUMMARY
06/27/2022 Letter INSPECTION SUMMARY
11/17/2021 Receipt Receipt for transaction:2021-008790
12/17/2021 Letter INSPECTION SUMMARY
12/17/2021 Letter INSPECTION SUMMARY
06/15/2021 Letter INSPECTION SUMMARY
06/22/2021 Letter INSPECTION SUMMARY
12/29/2021 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
10/13/2022 Letter INSPECTION SUMMARY
10/21/2022 Letter INSPECTION SUMMARY
10/21/2022 Letter INSPECTION SUMMARY
10/26/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
01/31/2022 image.jpg
02/08/2023 GRADING - G1
02/08/2023 500 NE OLIVE ST GRADING SUBMITTAL
08/11/2023 Letter INSPECTION SUMMARY
08/25/2023 Letter INSPECTION SUMMARY
08/25/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
12/05/2023 Letter INSPECTION SUMMARY
10/09/2020 Engineers Estimate 18-0251 Sequoia EOPC Signed
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 image.jpg3
02/01/2022 Letter INSPECTION SUMMARY
04/13/2022 image3
04/13/2022 image4
06/27/2022 image5
06/28/2022 Letter INSPECTION SUMMARY
04/07/2022 Letter INSPECTION SUMMARY
04/11/2022 image
04/12/2022 image0
04/13/2022 image1
04/13/2022 image2
04/13/2022 Letter INSPECTION SUMMARY
04/13/2022 Letter INSPECTION SUMMARY
03/26/2024 Letter SIGNED SUBSTANTIAL COMPLETION

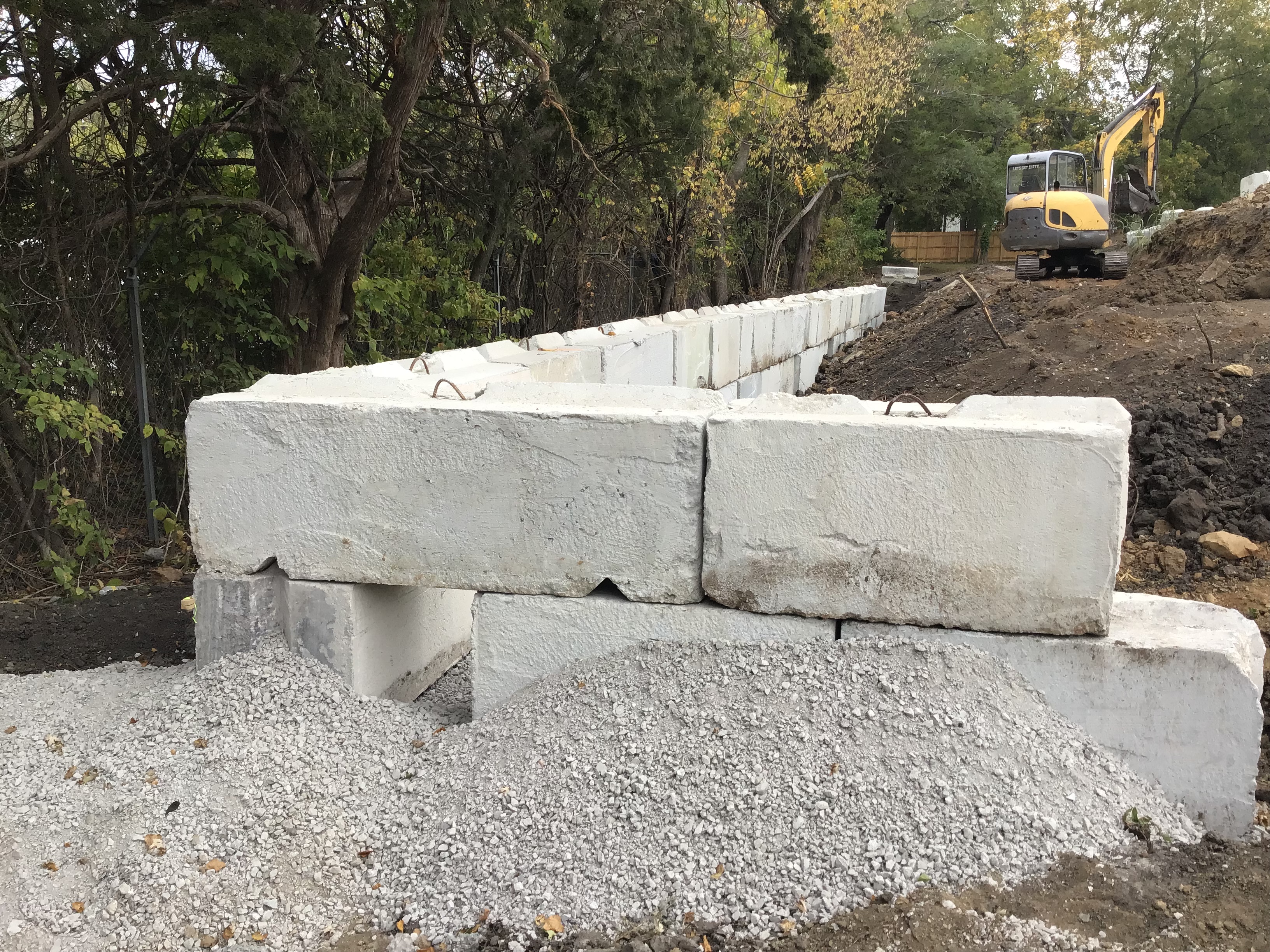

09/19/2022 Retaining Wall 1
09/19/2022 Retaining Wall 2
11/16/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter INSPECTION SUMMARY
09/21/2022 Letter INSPECTION SUMMARY
10/05/2022 Retaining Wall #1
10/05/2022 Retaining Wall #2
03/14/2024 Activity Document FeeWorksheet Public
03/14/2024 Letter DE-Certificate of Substantial Completion Single Lot
03/14/2024 Letter DE-Punch List
03/26/2024 Security Document 3-YEAR MAINTENANCE BOND
03/26/2024 Letter SIGNED FINAL AFFIDAVIT AND AGREEMENT
03/26/2024 Letter SIGNED PUNCH LIST
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
