Permit Application Status

PRSITE20215290

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSITE20215290
Development - Site
Final Acceptance
WEST PRYOR OWNERS ASSOCIATION INC
DEVELOPMENT COMPLETE
STREETS OF WEST PRYOR - PHASE II LOWENSTEIN DRIVE IMPROVEMENTS
10/08/2021
03/08/2022
03/01/2024
Locations
Contacts
WEST PRYOR OWNERS ASSOCIATION INC, Address:7200 W 132ND ST STE 109
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 10/08/2021 02/04/2022
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
9110068-Storm Fee $3,296.70 $3,296.70 Paid 02/15/2022
9110081-Paved Surface Inspection Fee $1,645.92 $1,645.92 Paid 02/15/2022
9110071-Site Grading Fee $141.60 $141.60 Paid 02/15/2022
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $280.00 $0.00 $280.00 Not Paid

$280.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 3/21/2022 3/21/2022 03/22/2022
Misc
Informational
03/22/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Erosion Control Inspection Partial 03/23/2022
Misc
Informational
03/23/2022
No erosion issues to report on the job site today. RP 3-23-22
Erosion Control Inspection Partial 03/24/2022
Misc
Informational
03/23/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
03/24/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Site Visit Partial 3/23/2022 3/23/2022 04/06/2022
Misc
Informational
03/22/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/06/2022
No utility work or grading being done today. RP 4-6-22
Site Visit Partial 4/7/2022 4/7/2022 04/19/2022
Misc
Informational
04/06/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/06/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/19/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Storm Sewer Construction Inspection Partial 04/19/2022
Misc
Informational
04/19/2022
Tyler’s crew started installation of the storm line. They got curb inlet E-4 set today. RP 4-19-22
Storm Sewer Construction Inspection Partial 4/20/2022 4/20/2022 04/20/2022
Misc
Informational
04/20/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Site Visit Partial 4/20/2022 4/20/2022 04/20/2022
Misc
Informational
04/19/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/19/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/19/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
04/20/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Storm Sewer Construction Inspection Partial 4/21/2022 4/21/2022 04/21/2022
Misc
Informational
04/20/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/21/2022

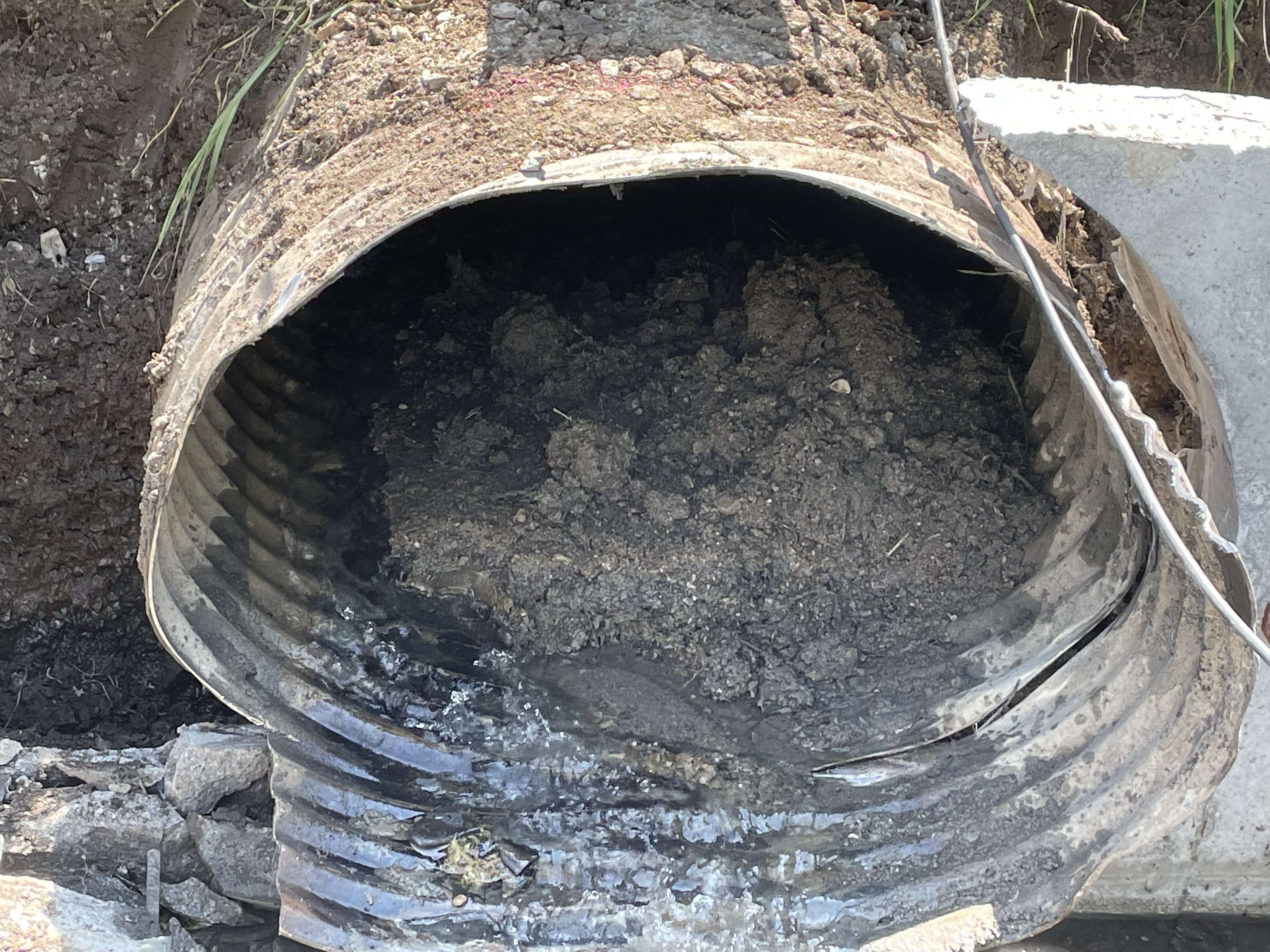

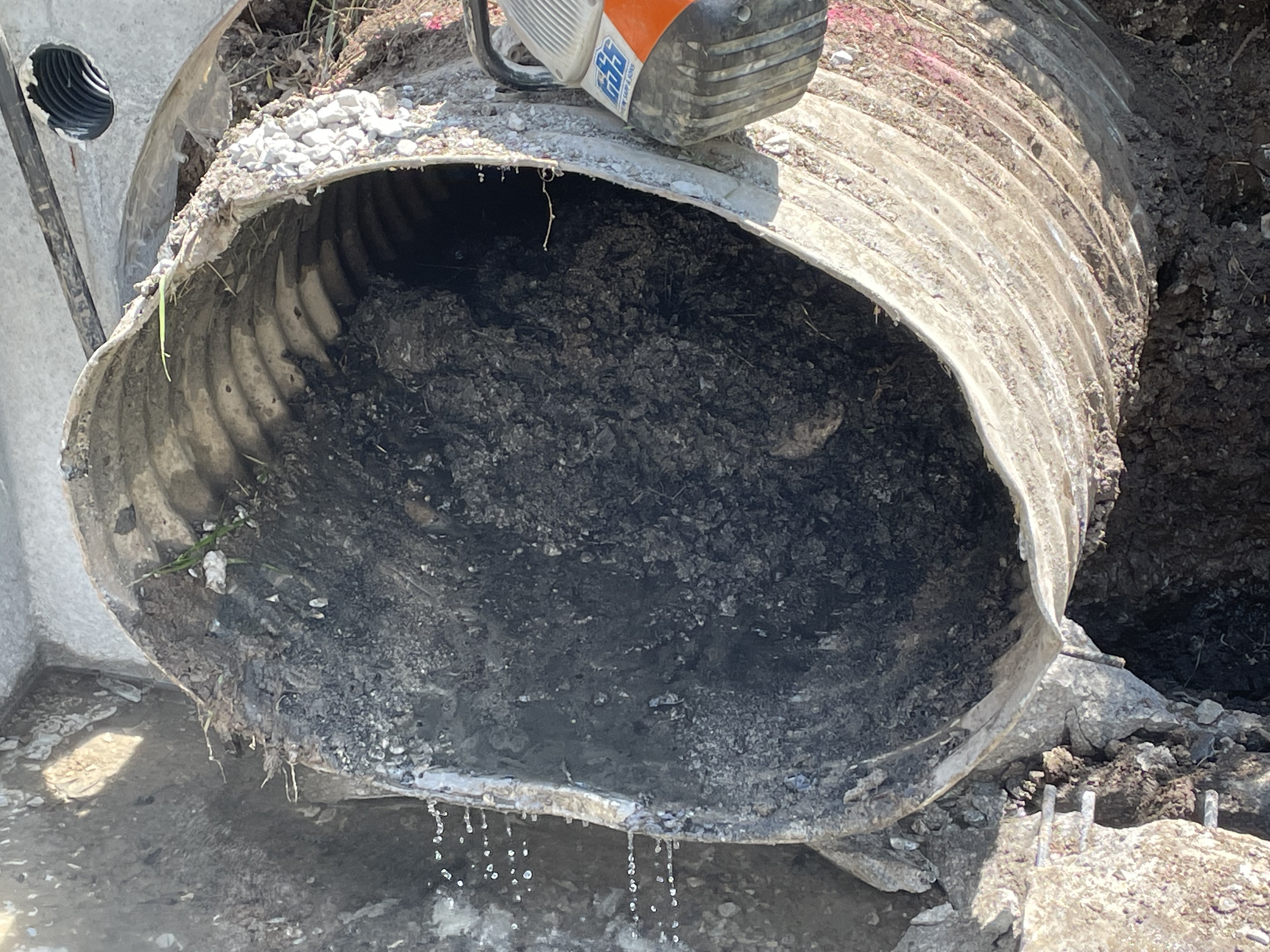

Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Storm Sewer Construction Inspection Partial 4/22/2022 4/22/2022 04/22/2022
Misc
Informational
04/21/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/21/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/22/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Storm Sewer Construction Inspection Partial 4/25/2022 4/25/2022 04/25/2022
Misc
Informational
04/22/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/22/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/22/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/25/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Storm Sewer Construction Inspection Partial 4/26/2022 4/26/2022 04/26/2022
Misc
Informational
04/25/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/25/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/25/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/25/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
04/26/2022

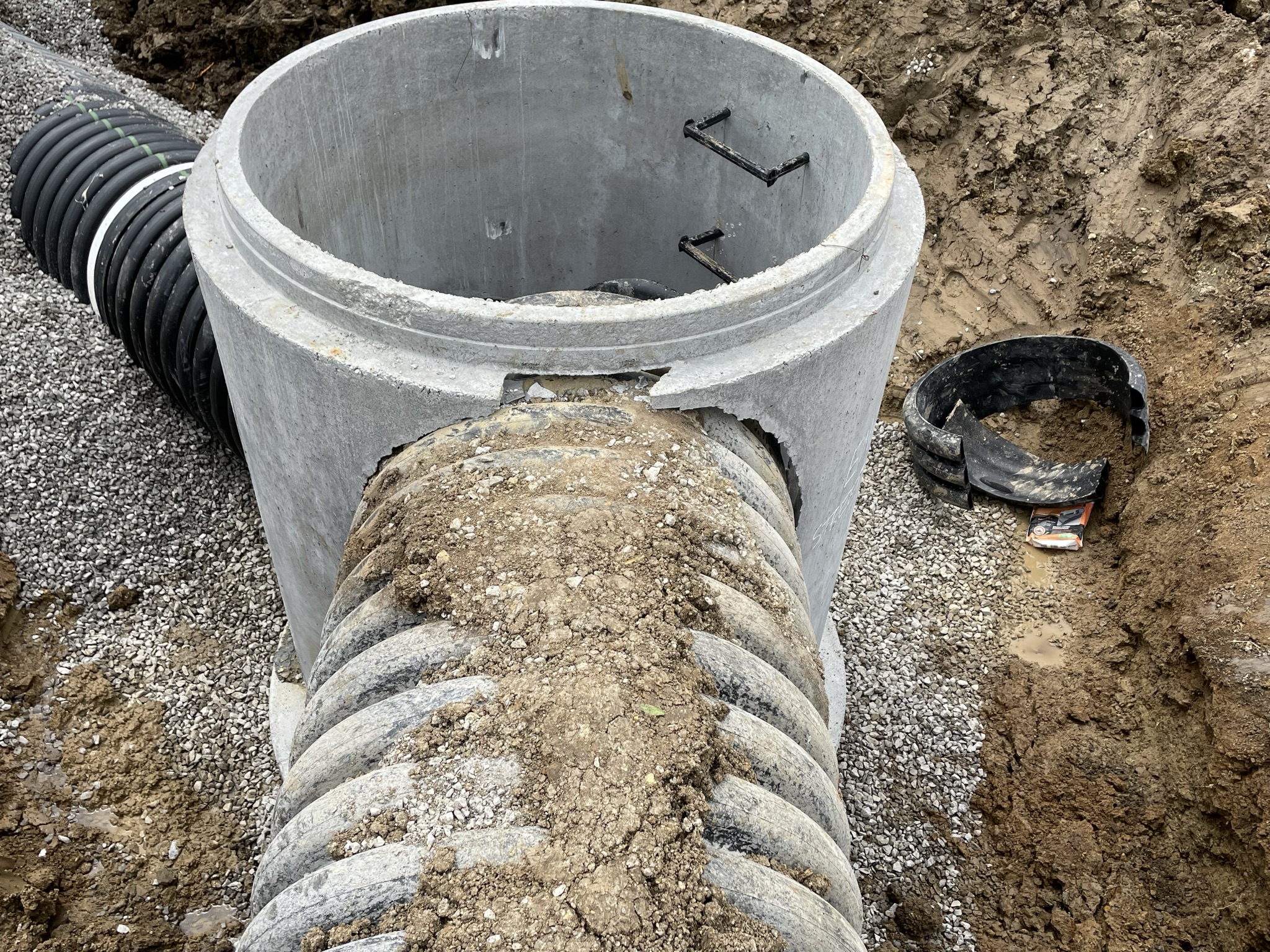

Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Site Visit Partial 04/27/2022
Misc
Informational
04/20/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/20/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
04/20/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
04/27/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Storm Sewer Construction Inspection Partial 04/27/2022
Misc
Informational
04/26/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/26/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/26/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/26/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
04/26/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
04/27/2022

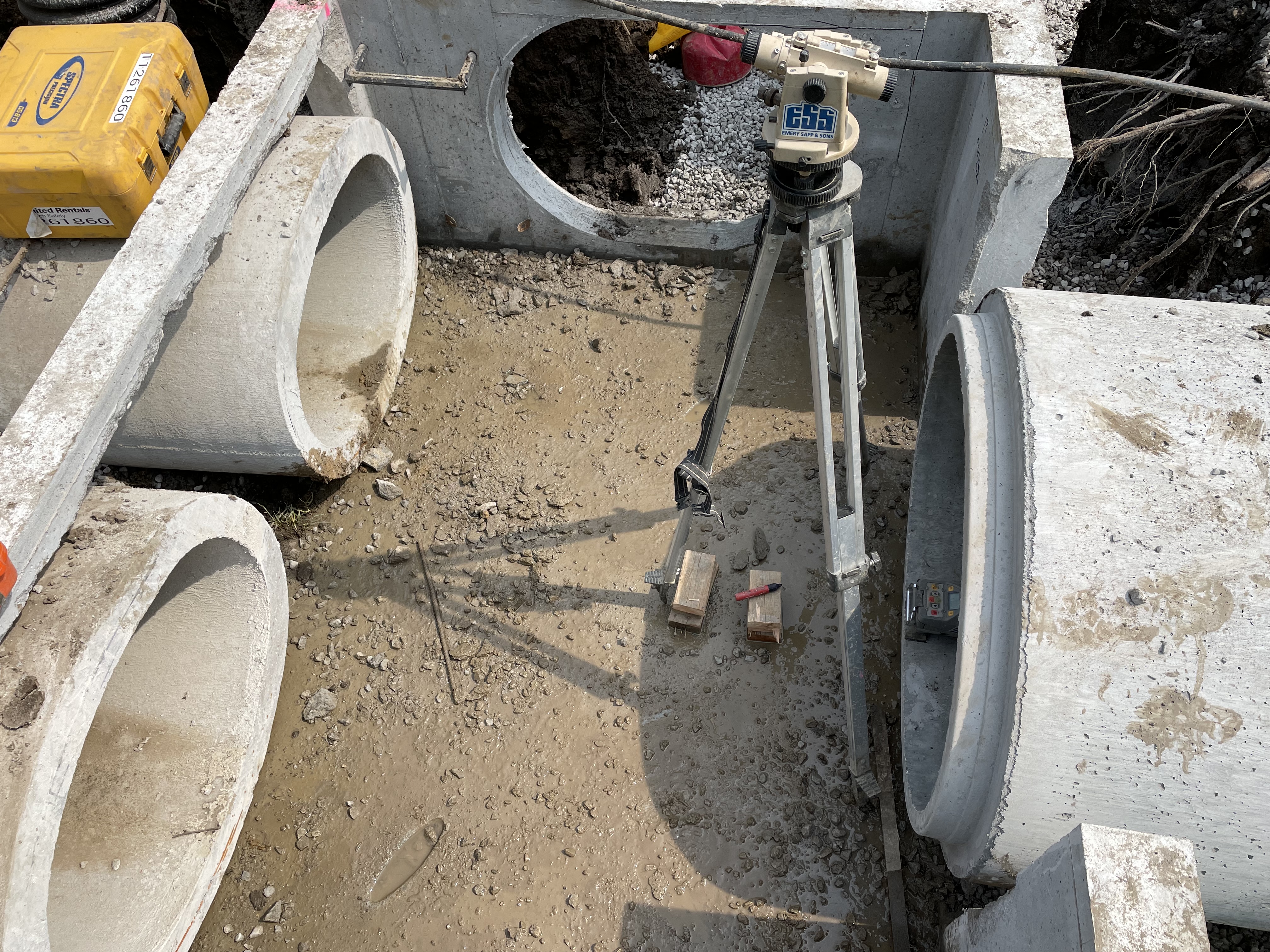

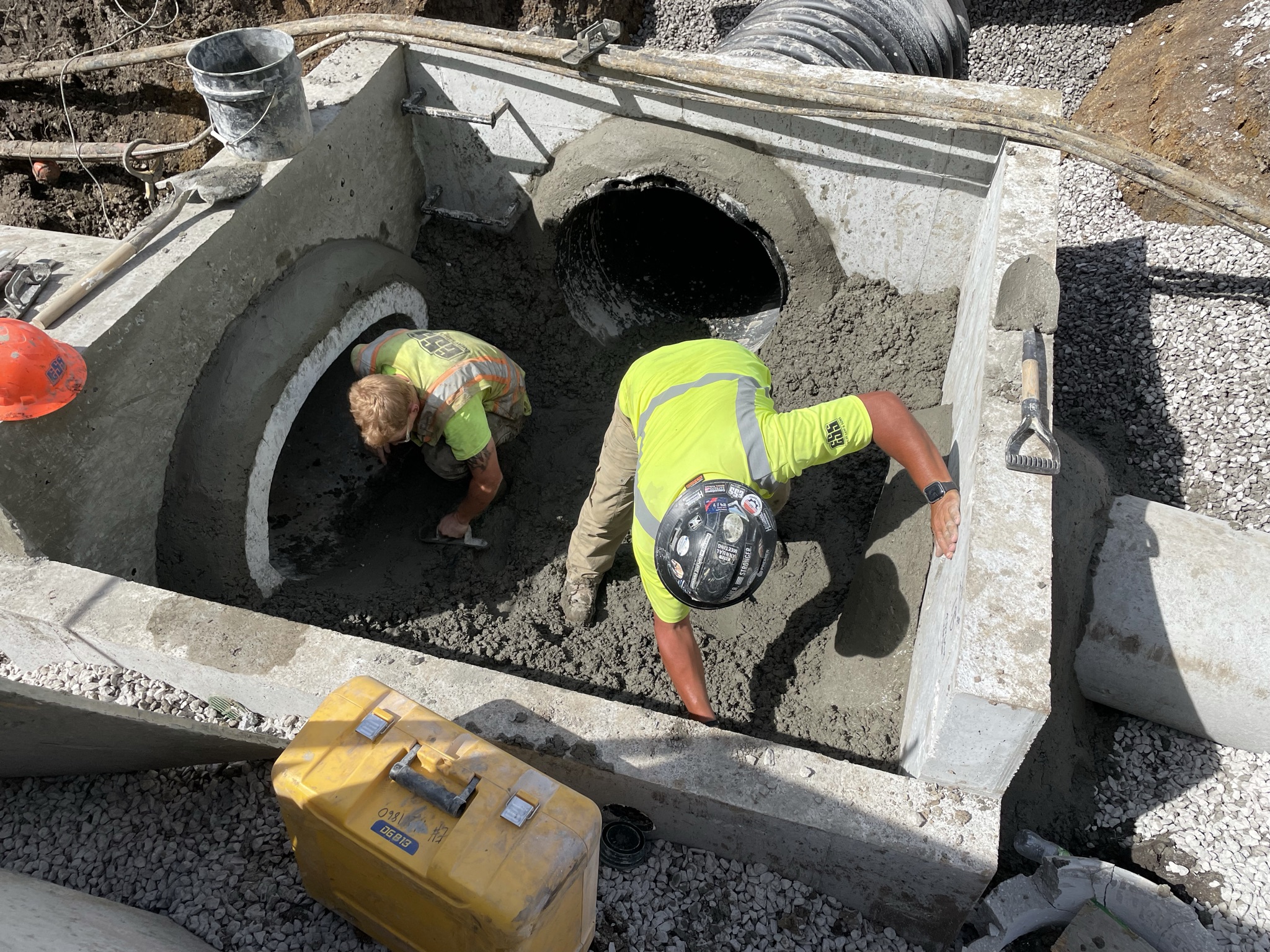

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Site Visit Partial 04/28/2022
Misc
Informational
04/27/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/27/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/27/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
04/27/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
04/27/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
04/28/2022
No work being performed today. 4/28/22 ES
Storm Sewer Construction Inspection Partial 04/29/2022
Misc
Informational
04/27/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/27/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/27/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/27/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
04/27/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
04/27/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
04/29/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Storm Sewer Construction Inspection Partial 04/29/2022
Misc
Informational
04/29/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/29/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/29/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/29/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
04/29/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
04/29/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
04/29/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
04/29/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Storm Sewer Construction Inspection Partial 5/3/2022 5/3/2022 05/03/2022
Misc
Informational
04/29/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
04/29/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
04/29/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
04/29/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
04/29/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
04/29/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
04/29/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
04/29/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/03/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Storm Sewer Construction Inspection Partial 05/03/2022
Misc
Informational
05/03/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/03/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/03/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/03/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/03/2022

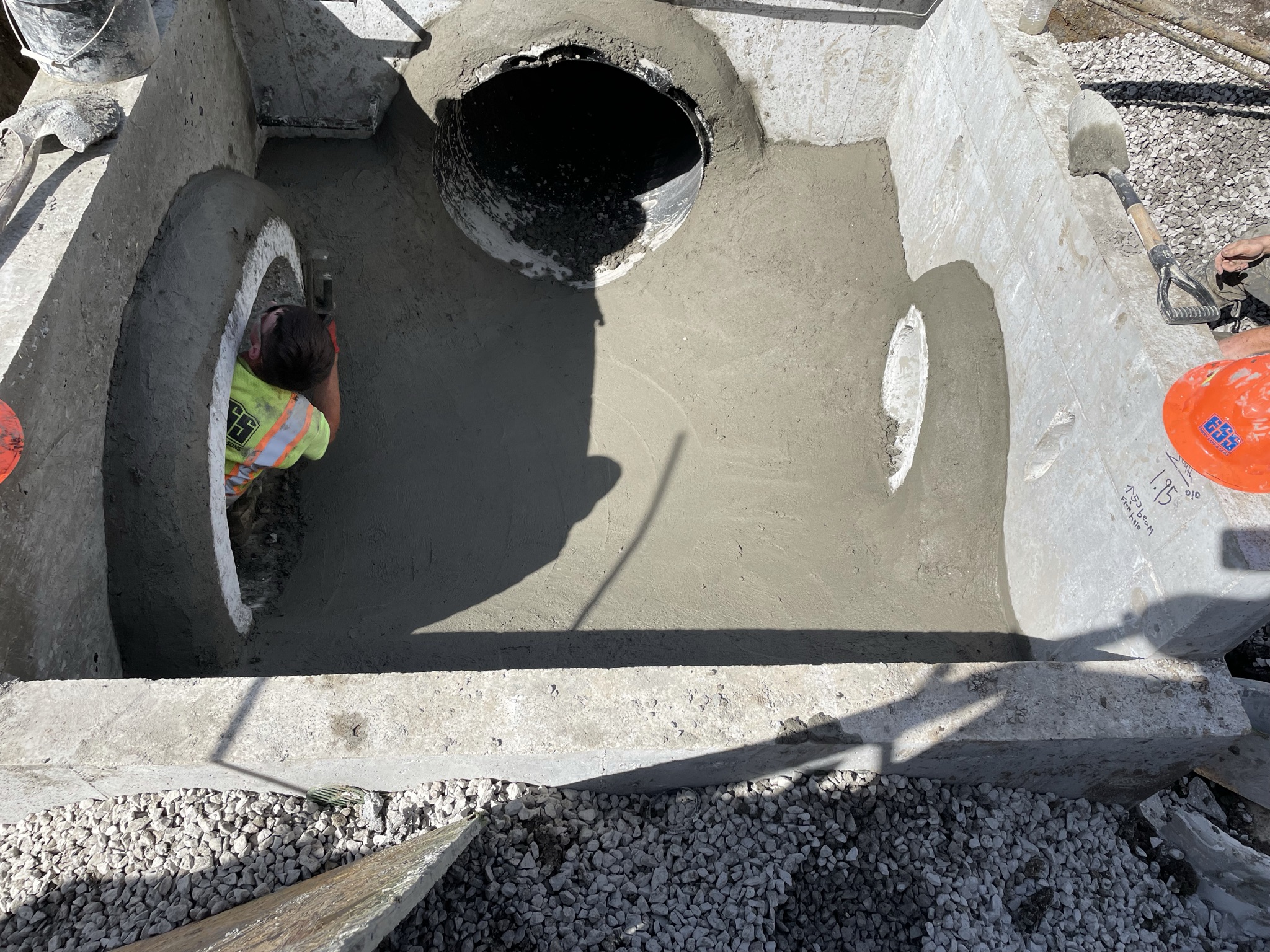

Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/03/2022

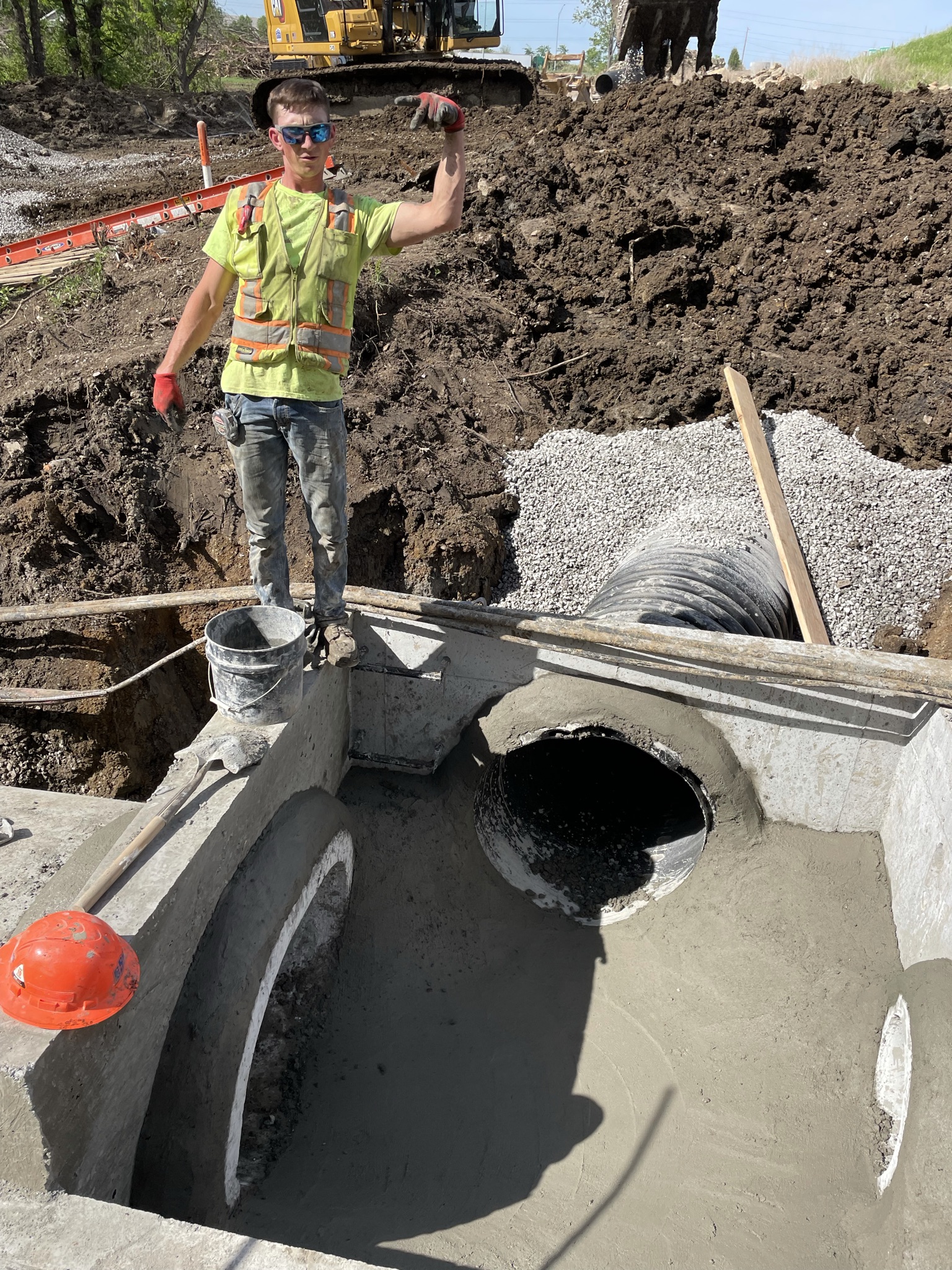

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/03/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/03/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/03/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/03/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES
Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/03/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/03/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/03/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/03/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/03/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/03/2022

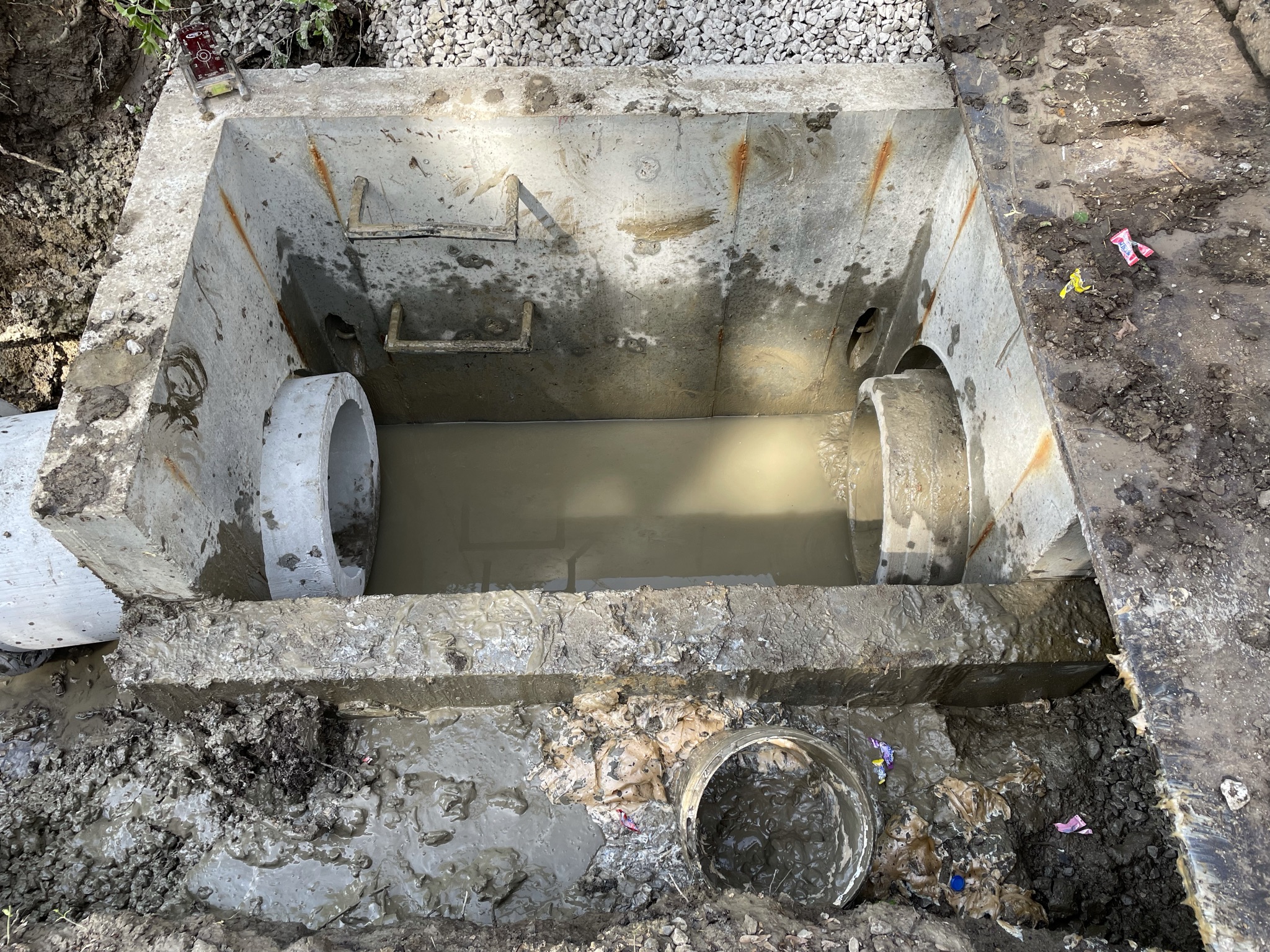

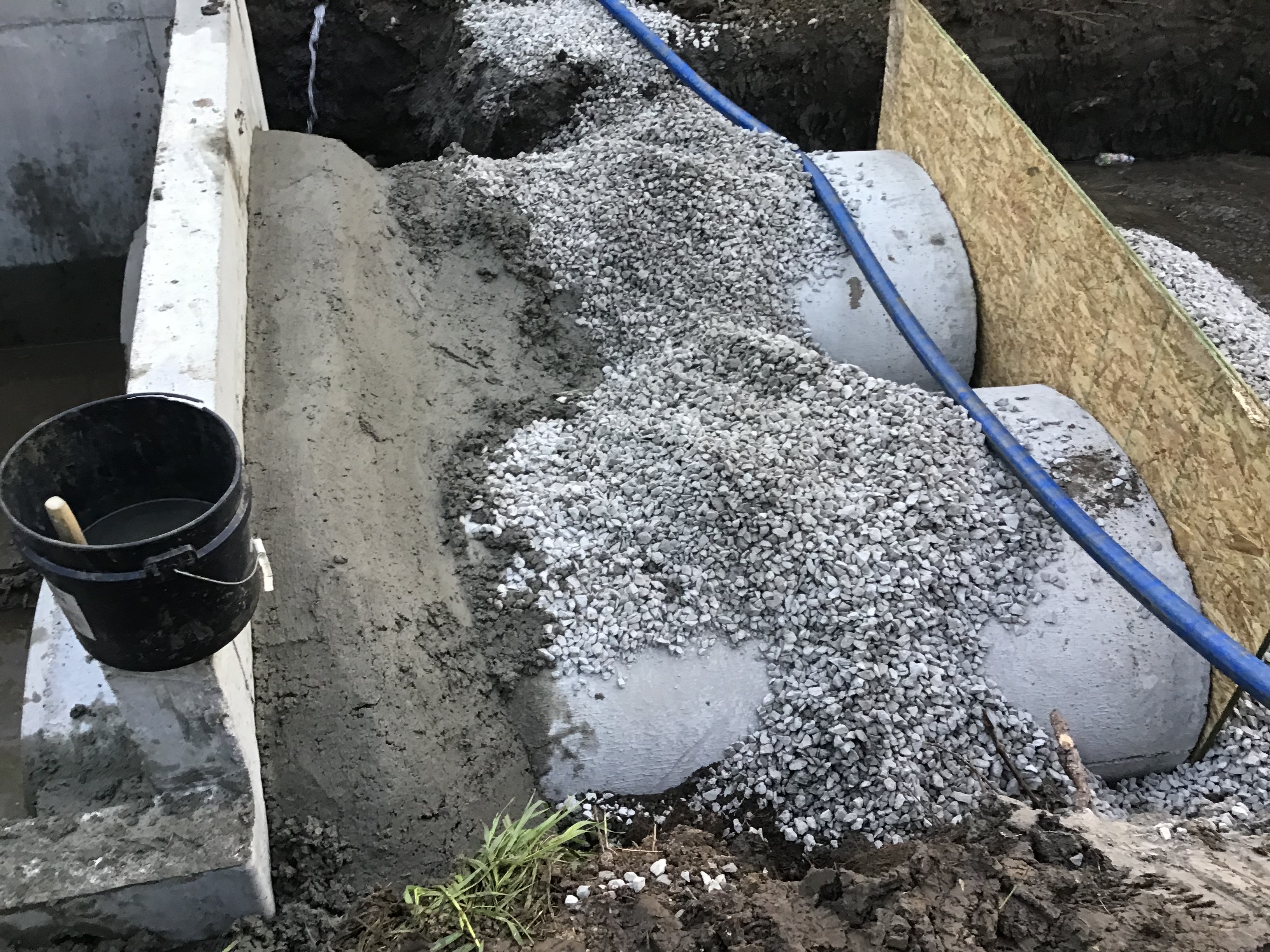

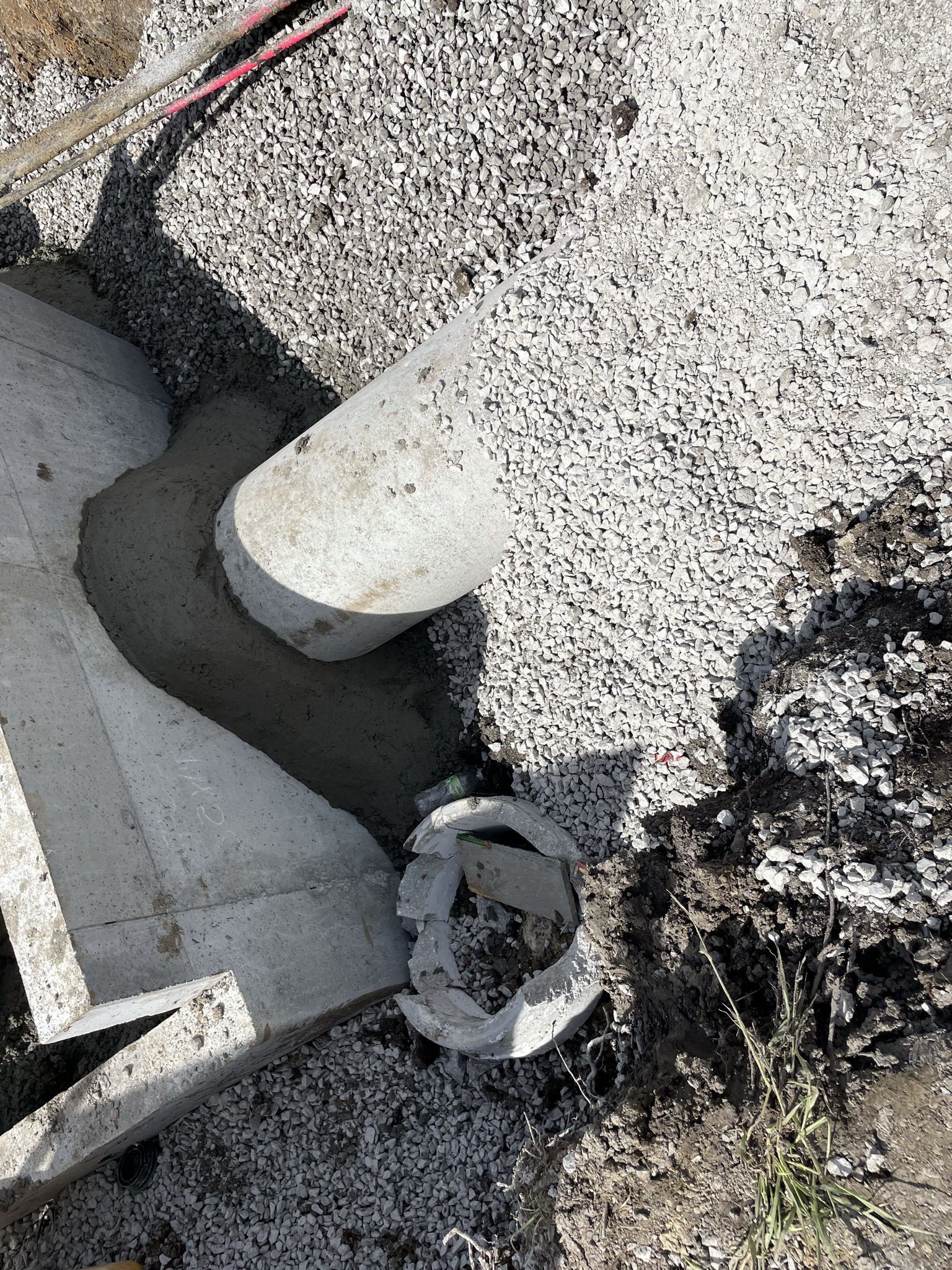

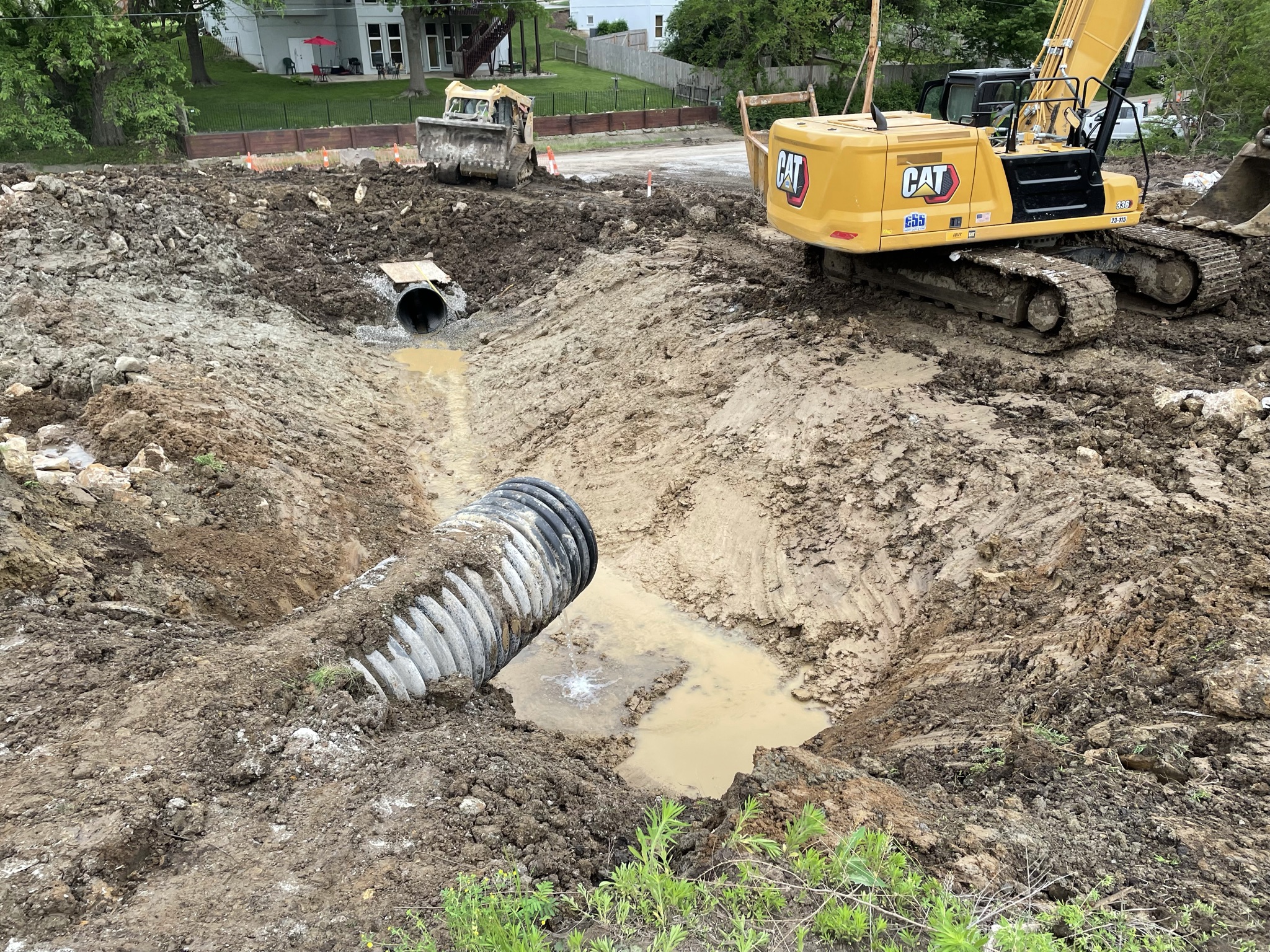

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/03/2022

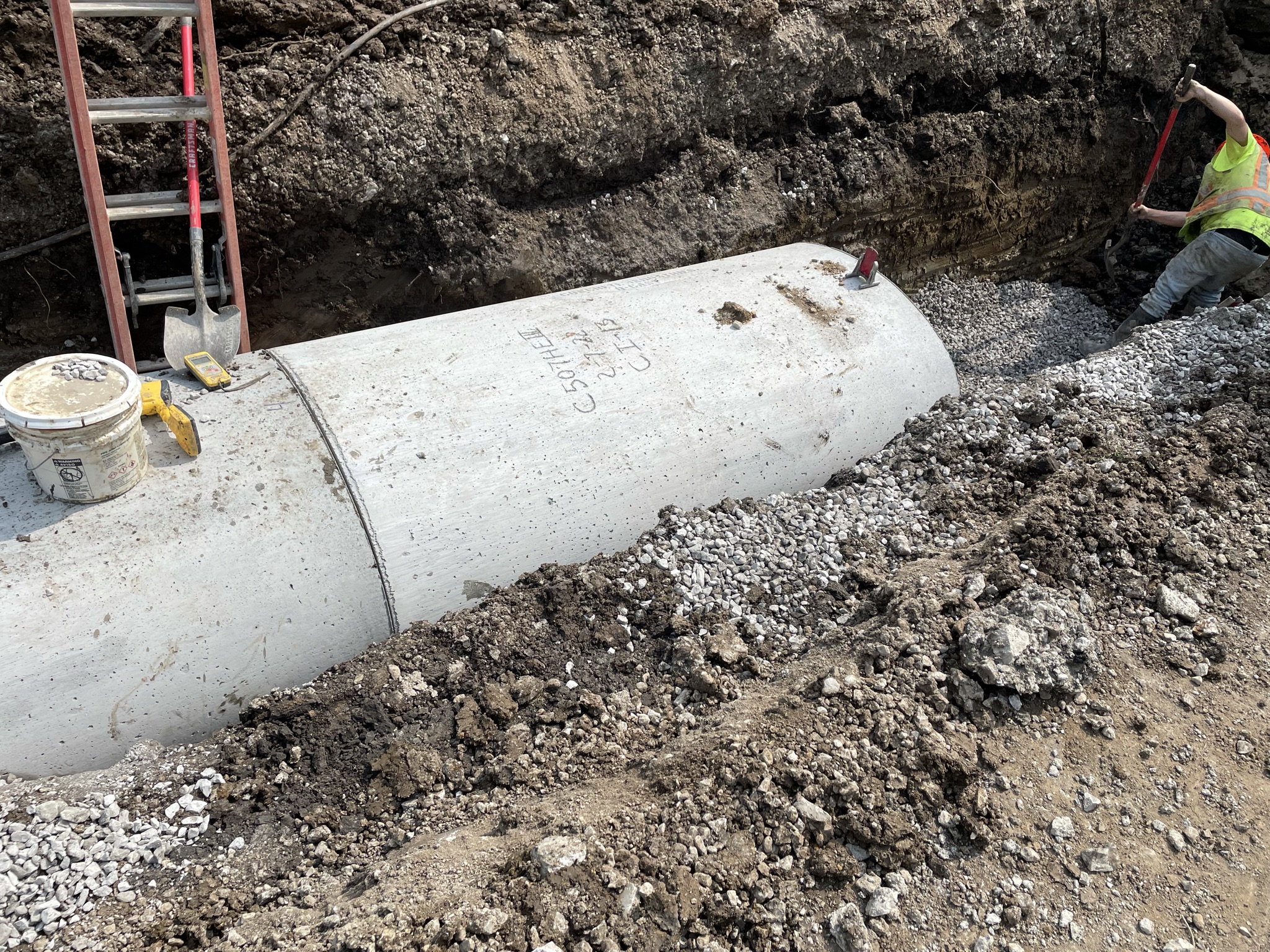

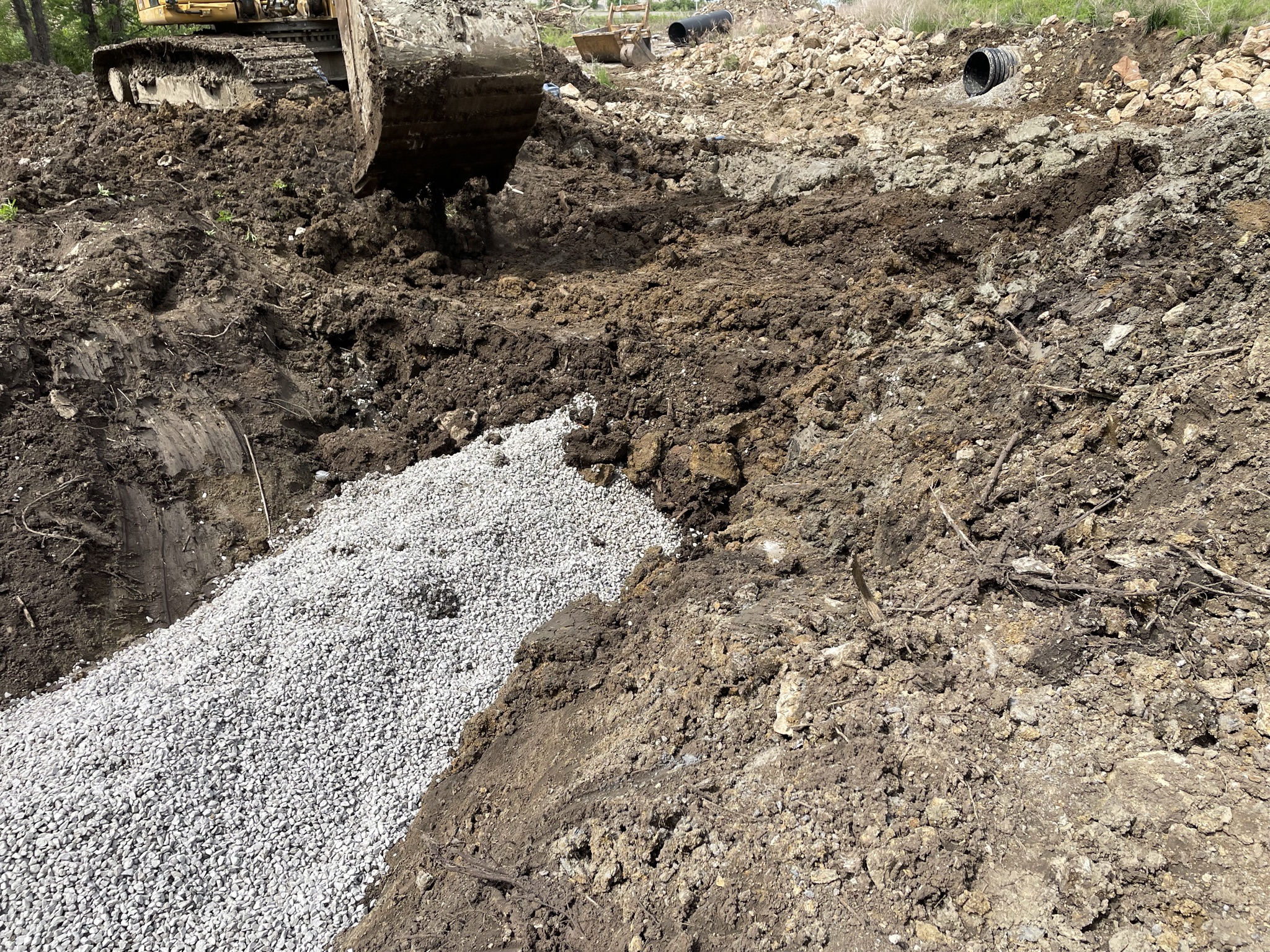

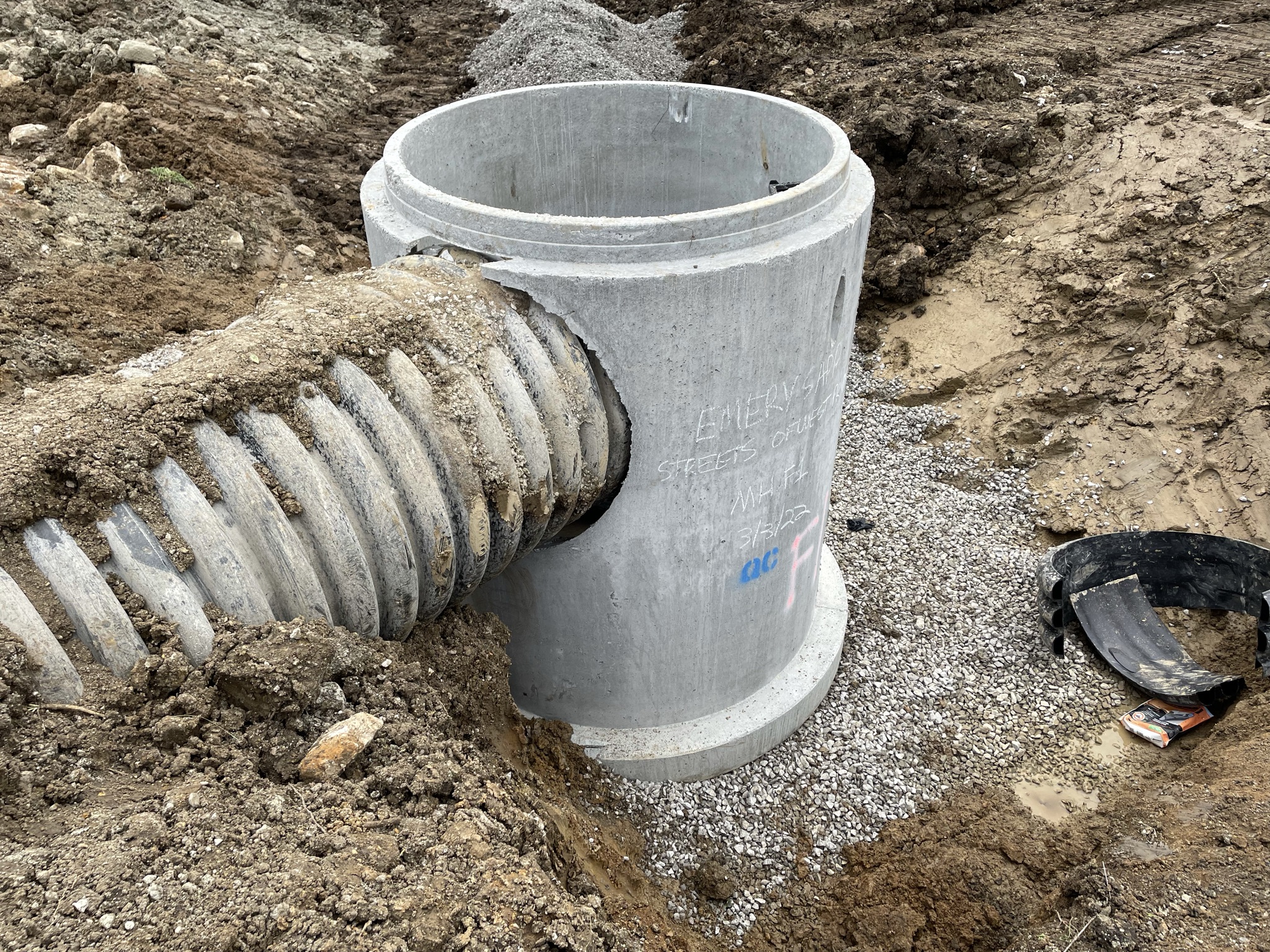

Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/03/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/03/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/03/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES
Misc
Corrective Action Required
05/12/2022

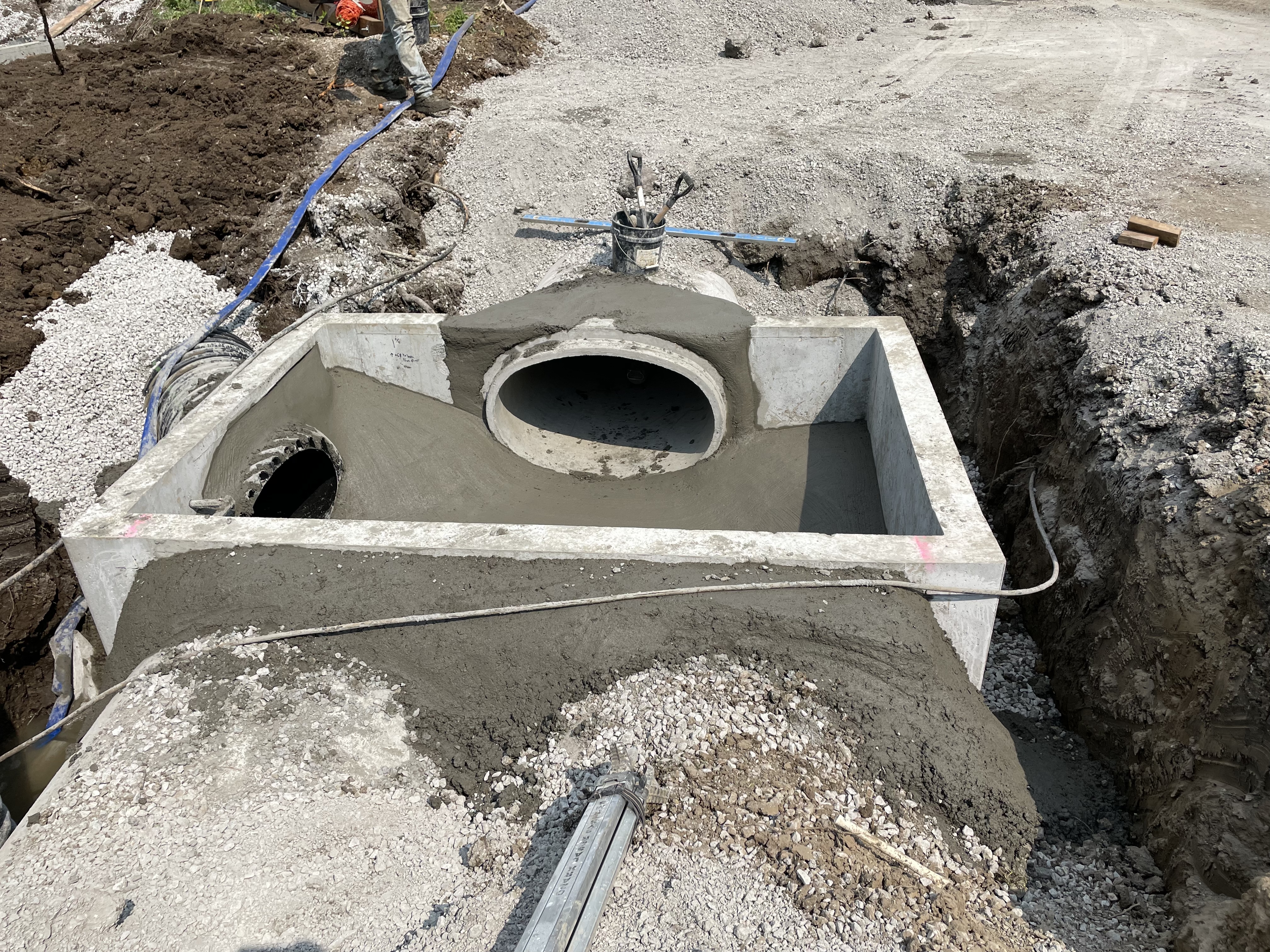

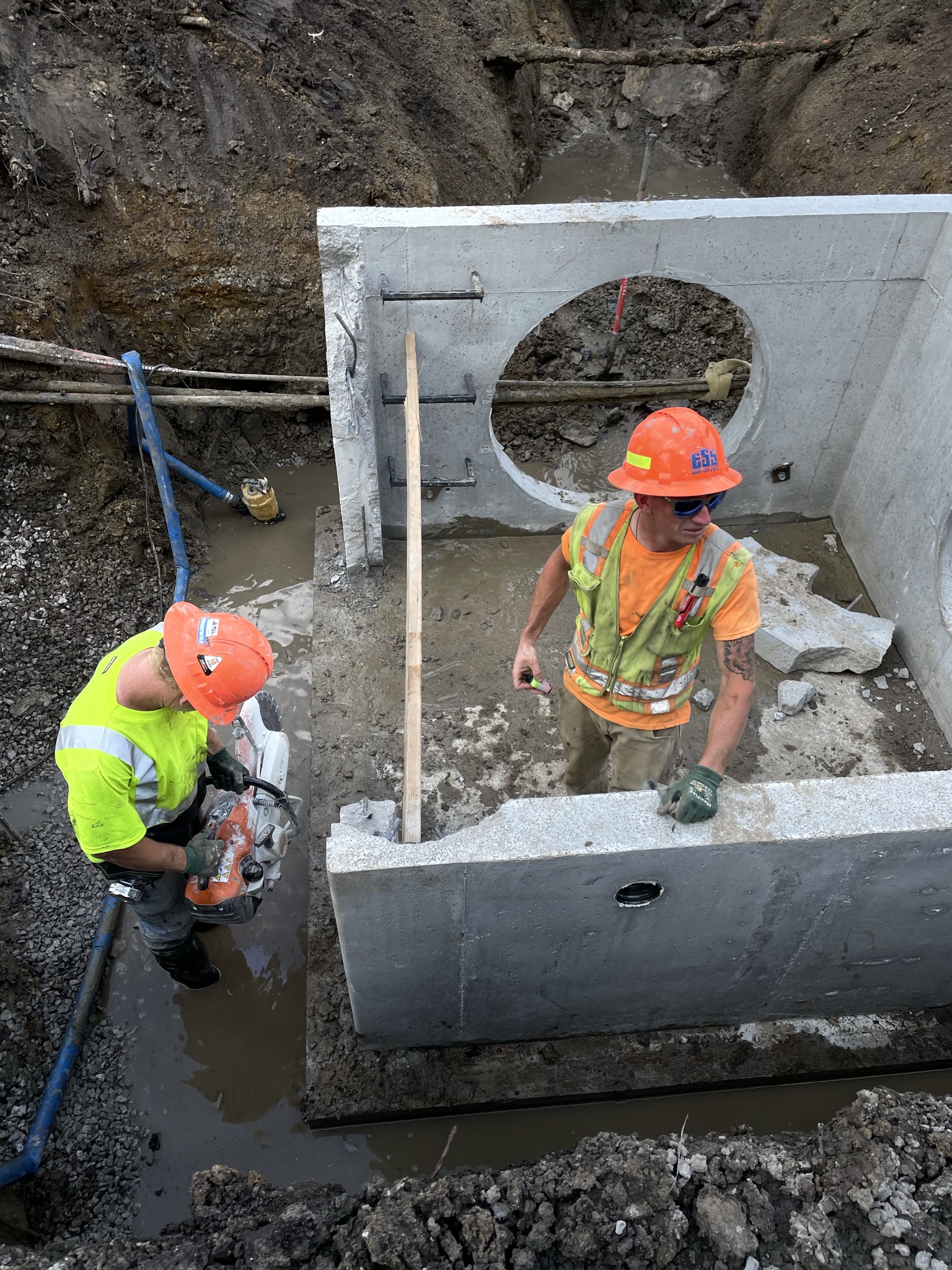

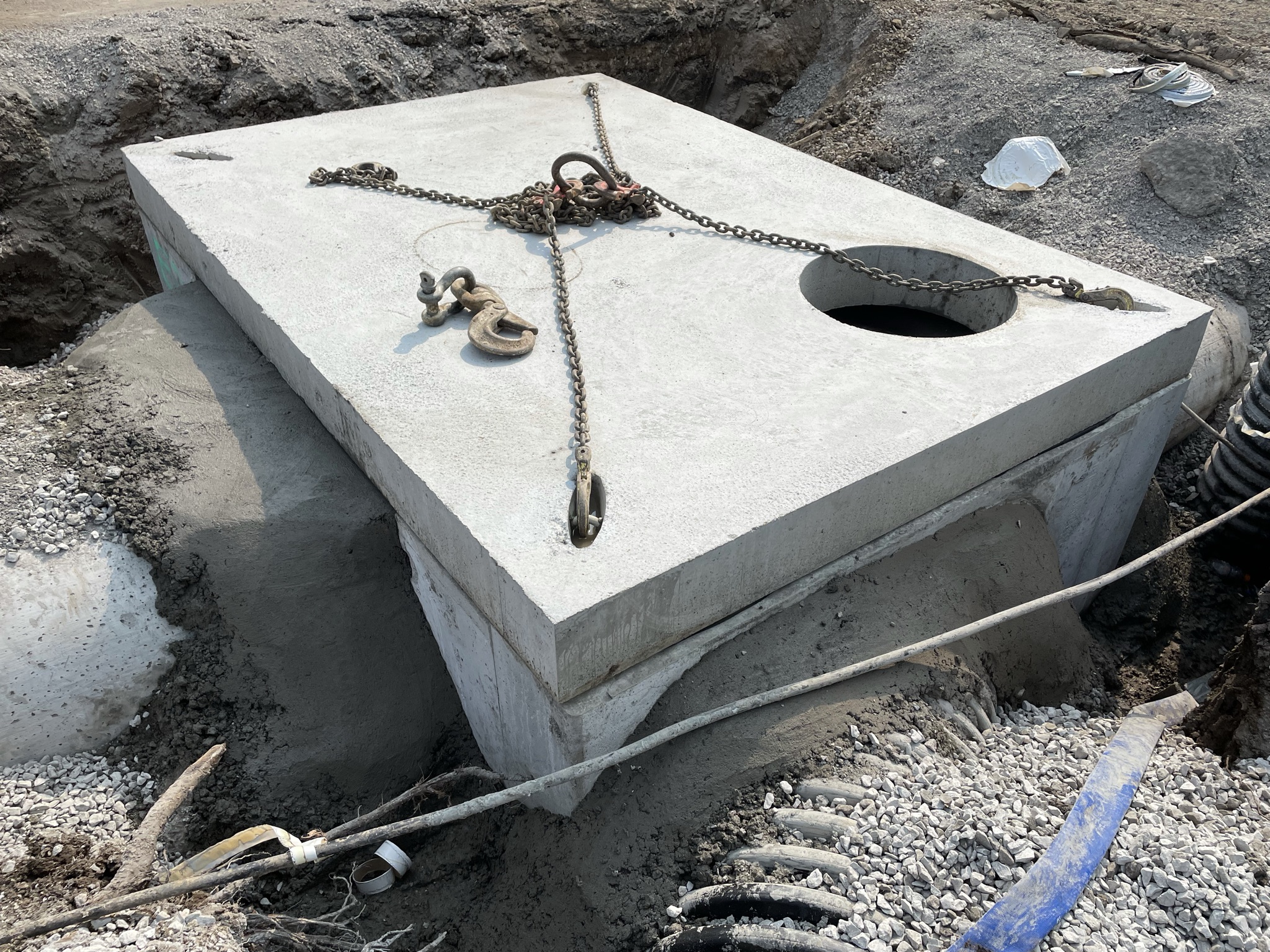

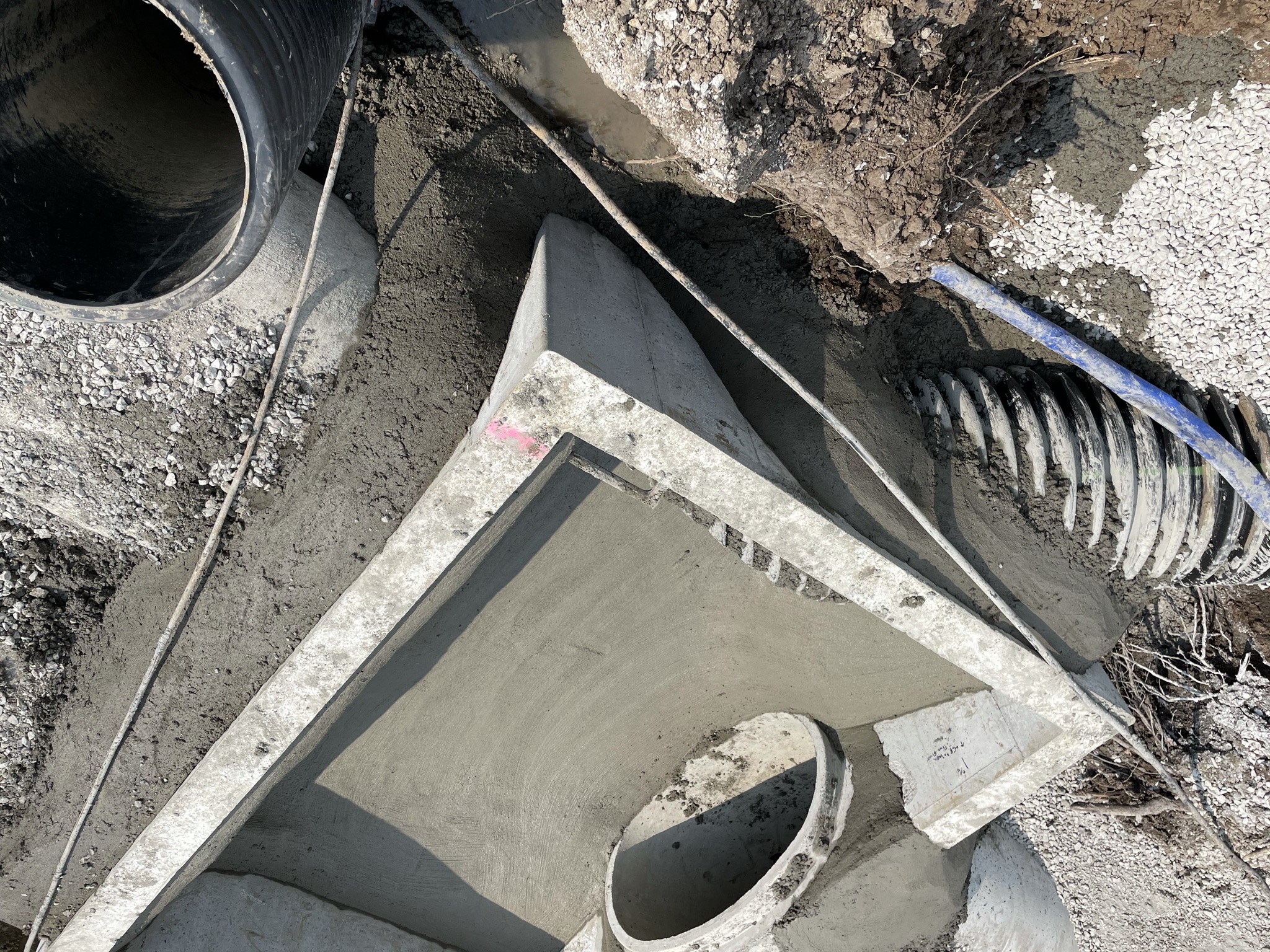

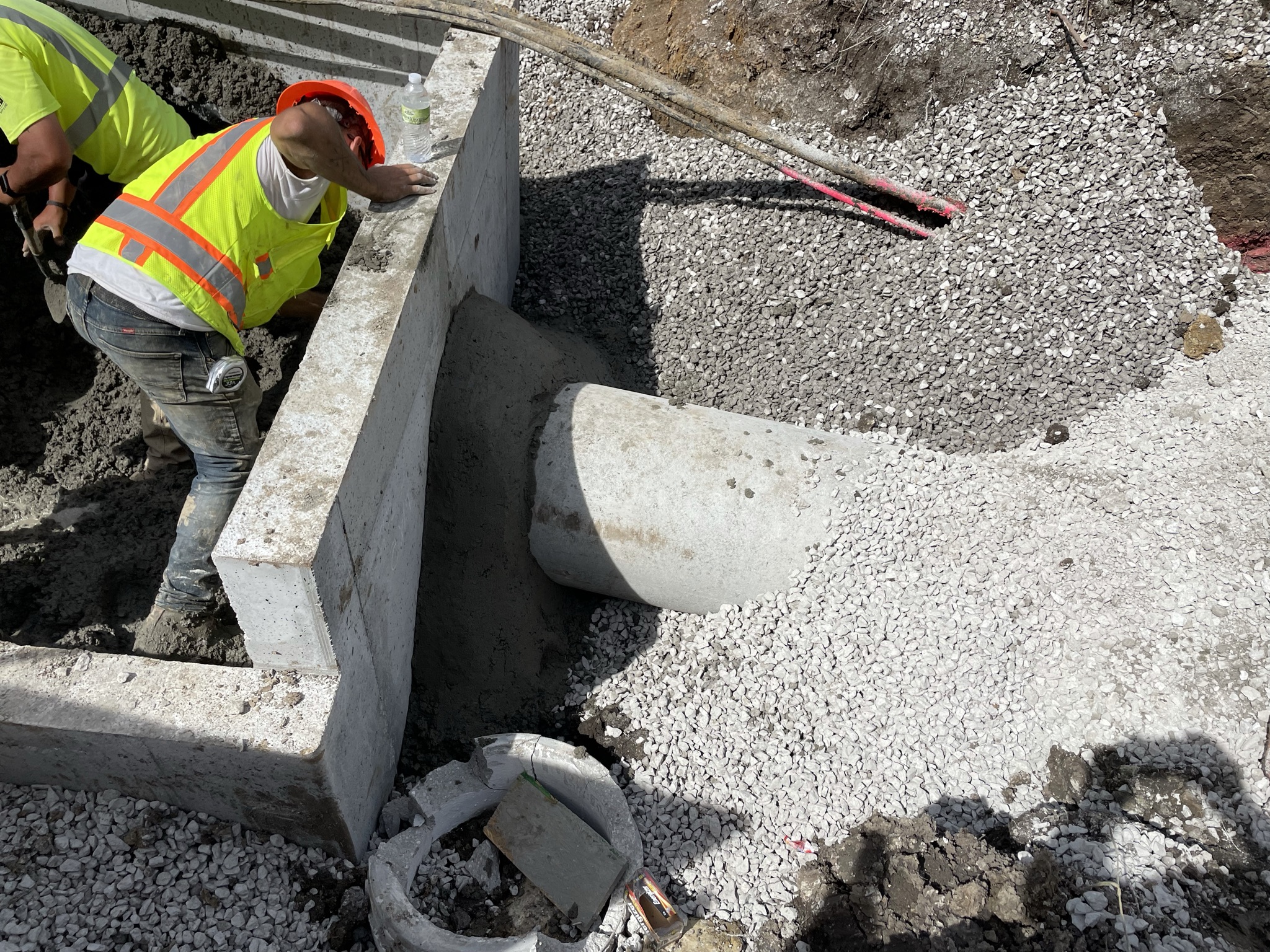

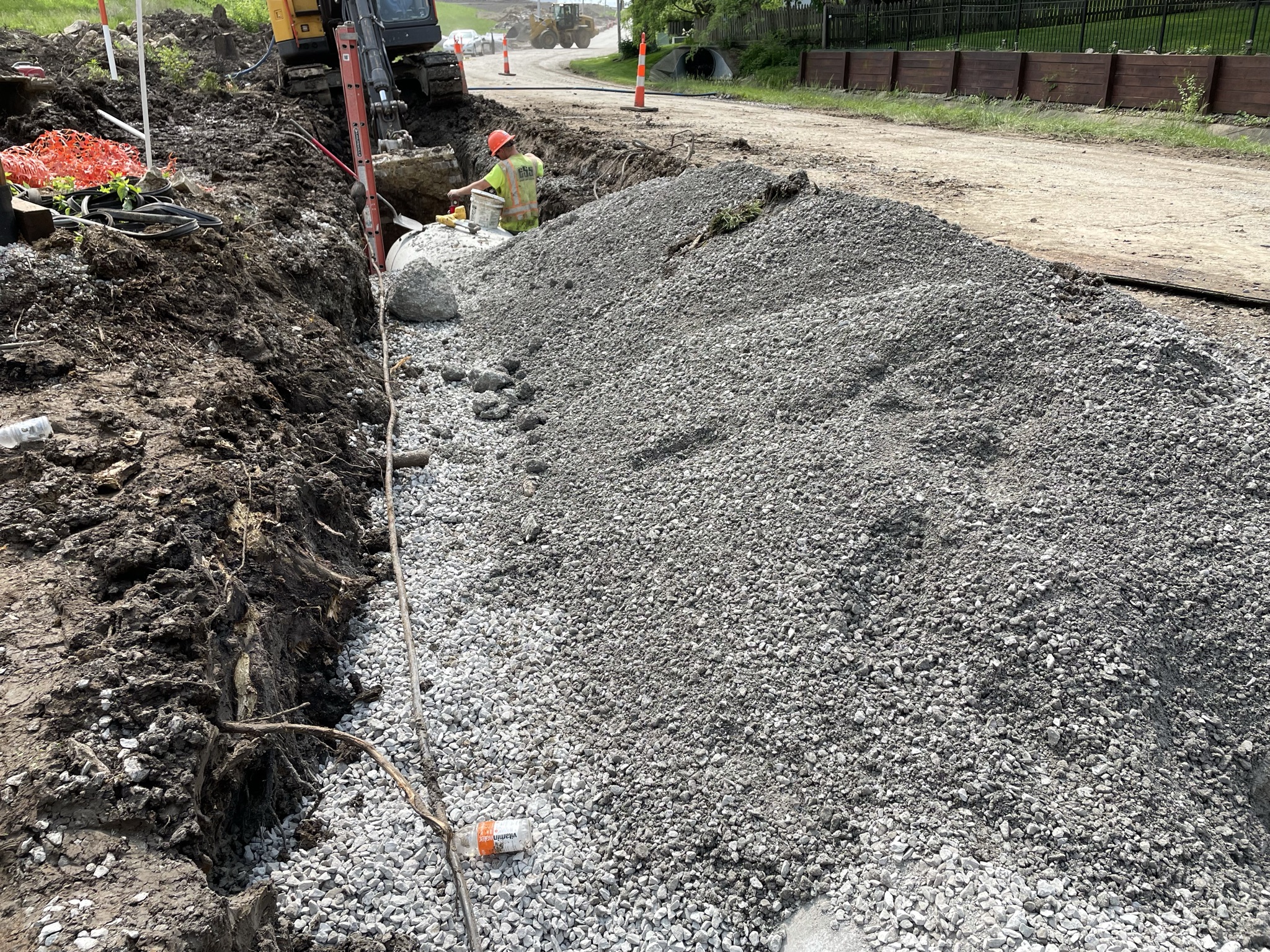

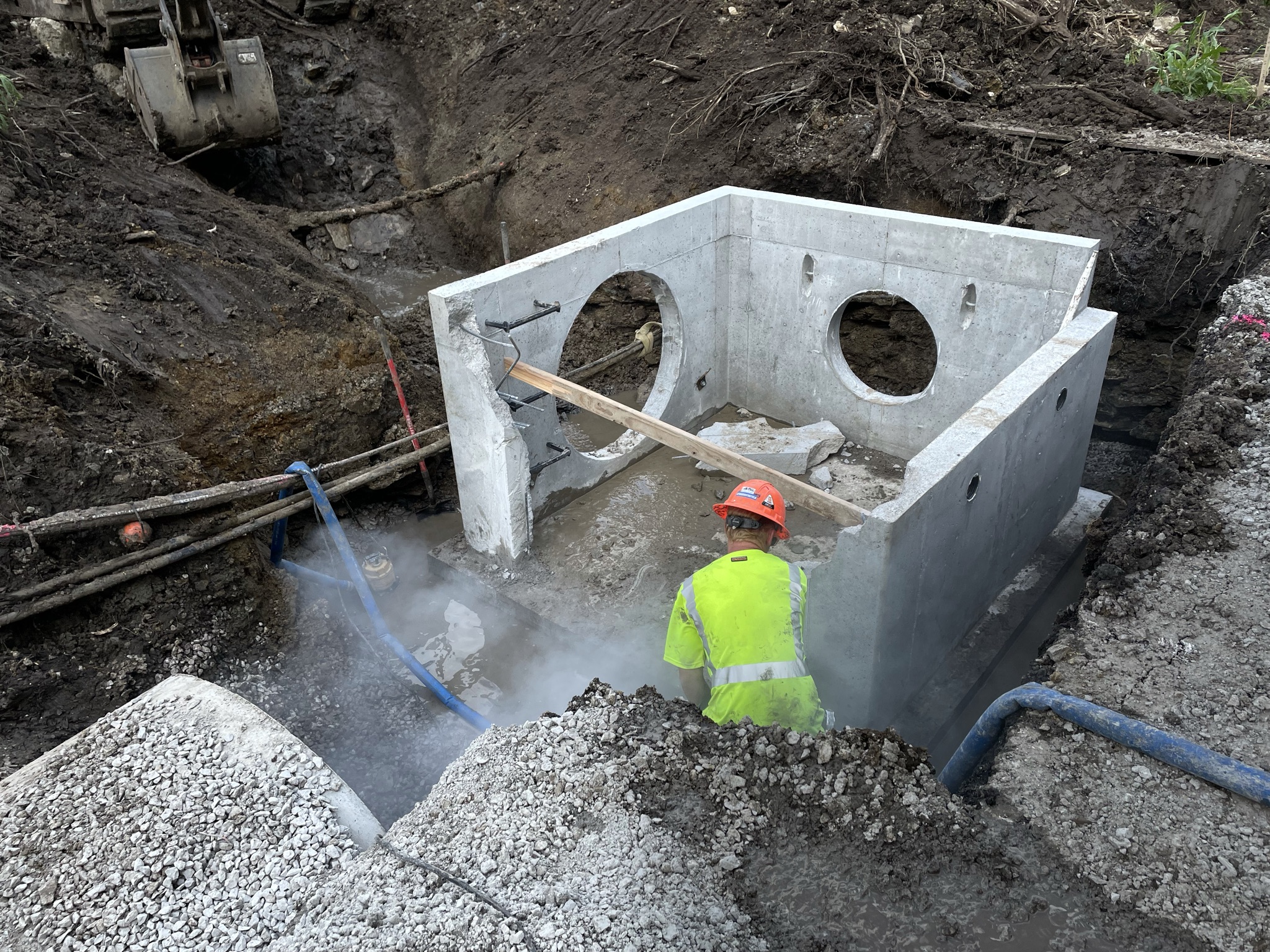

5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached

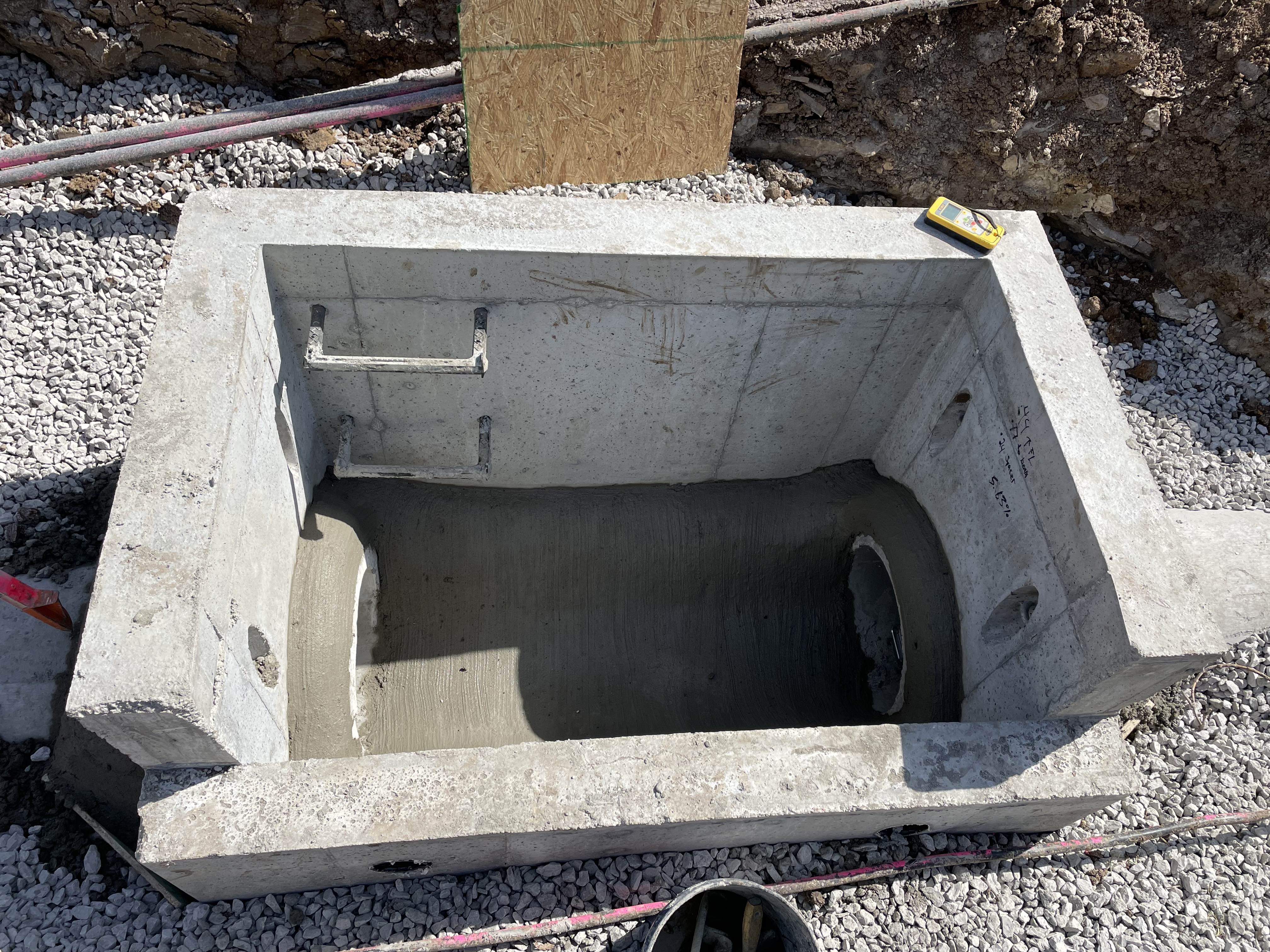

Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/12/2022

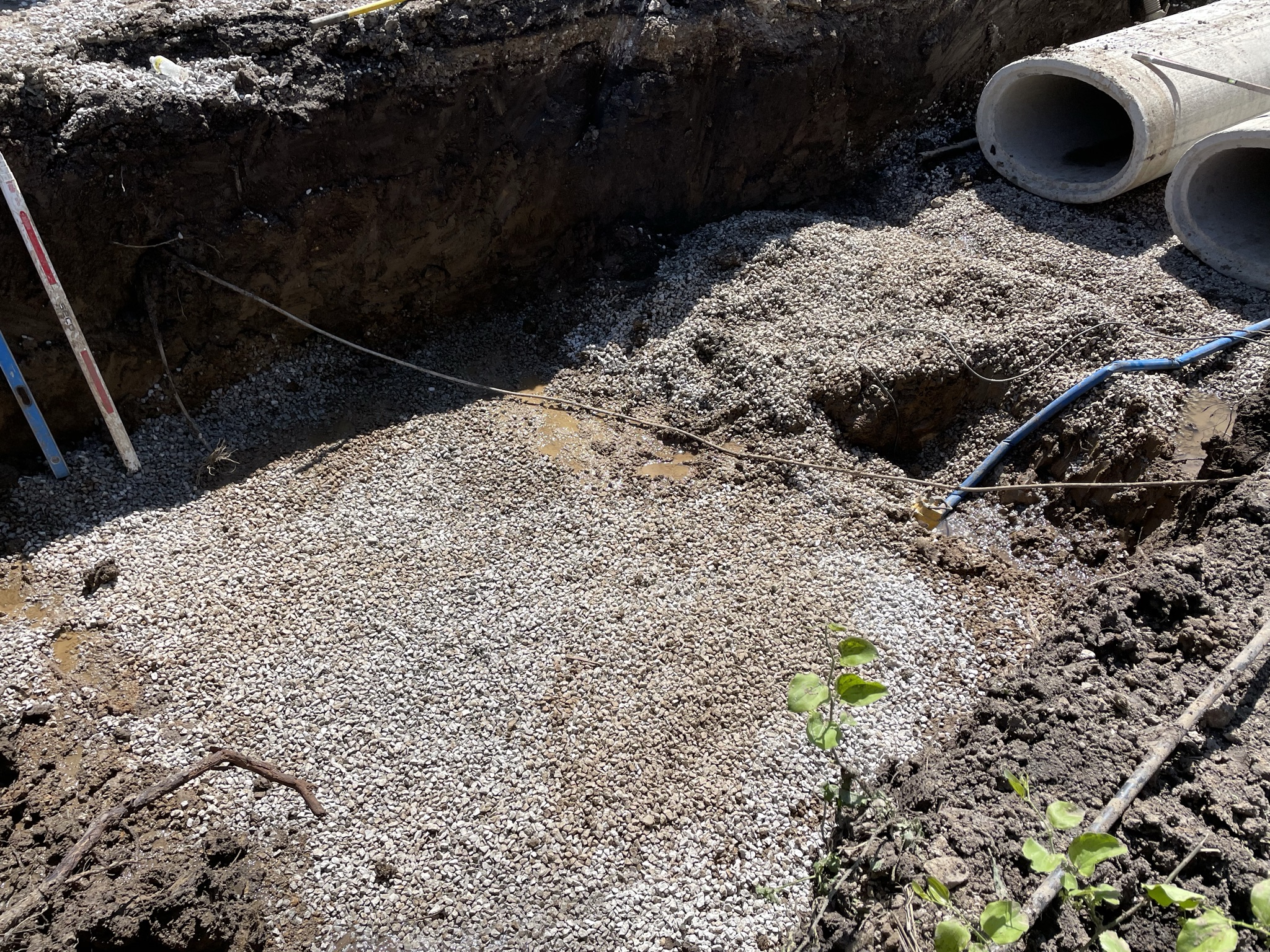

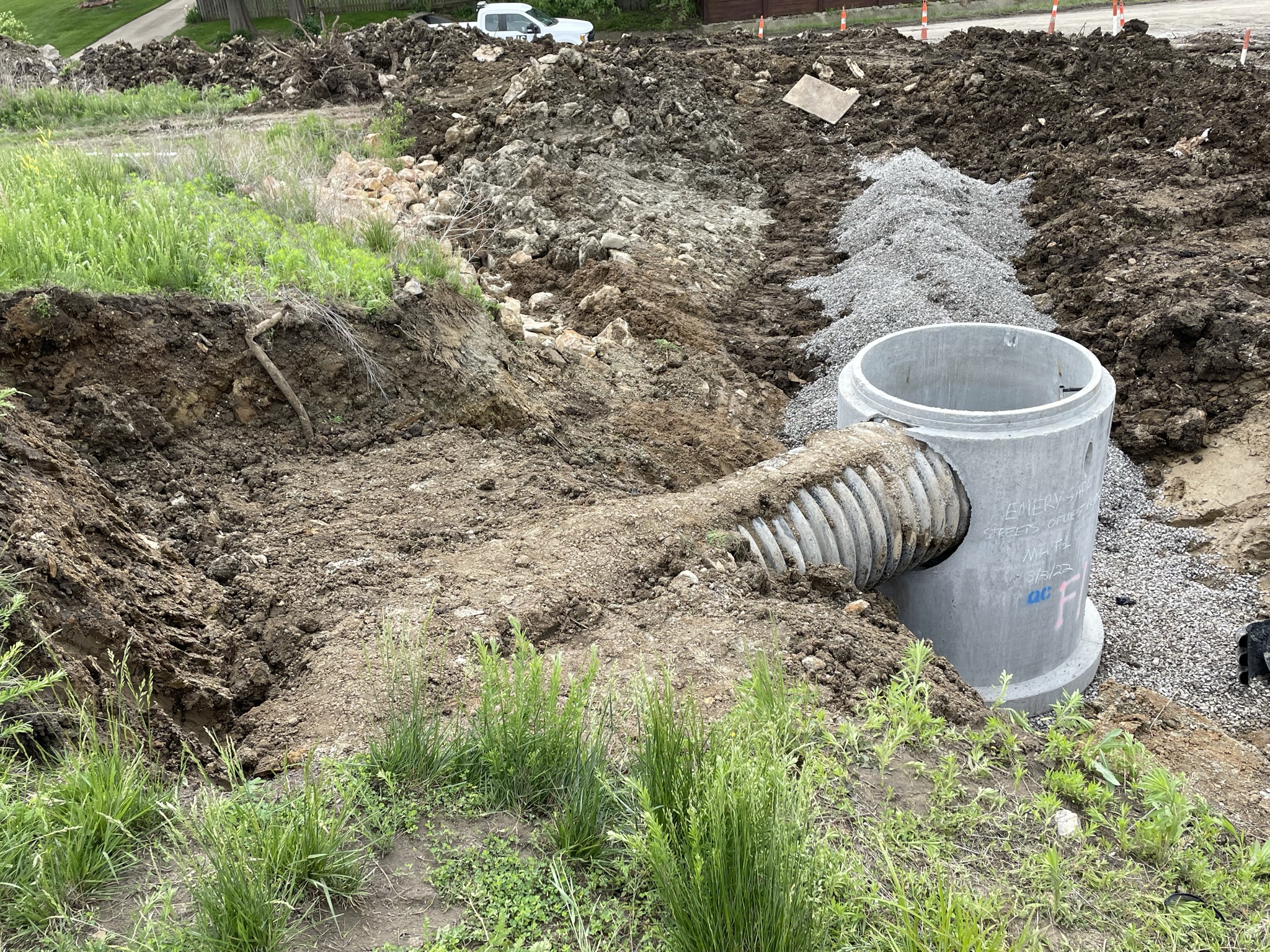

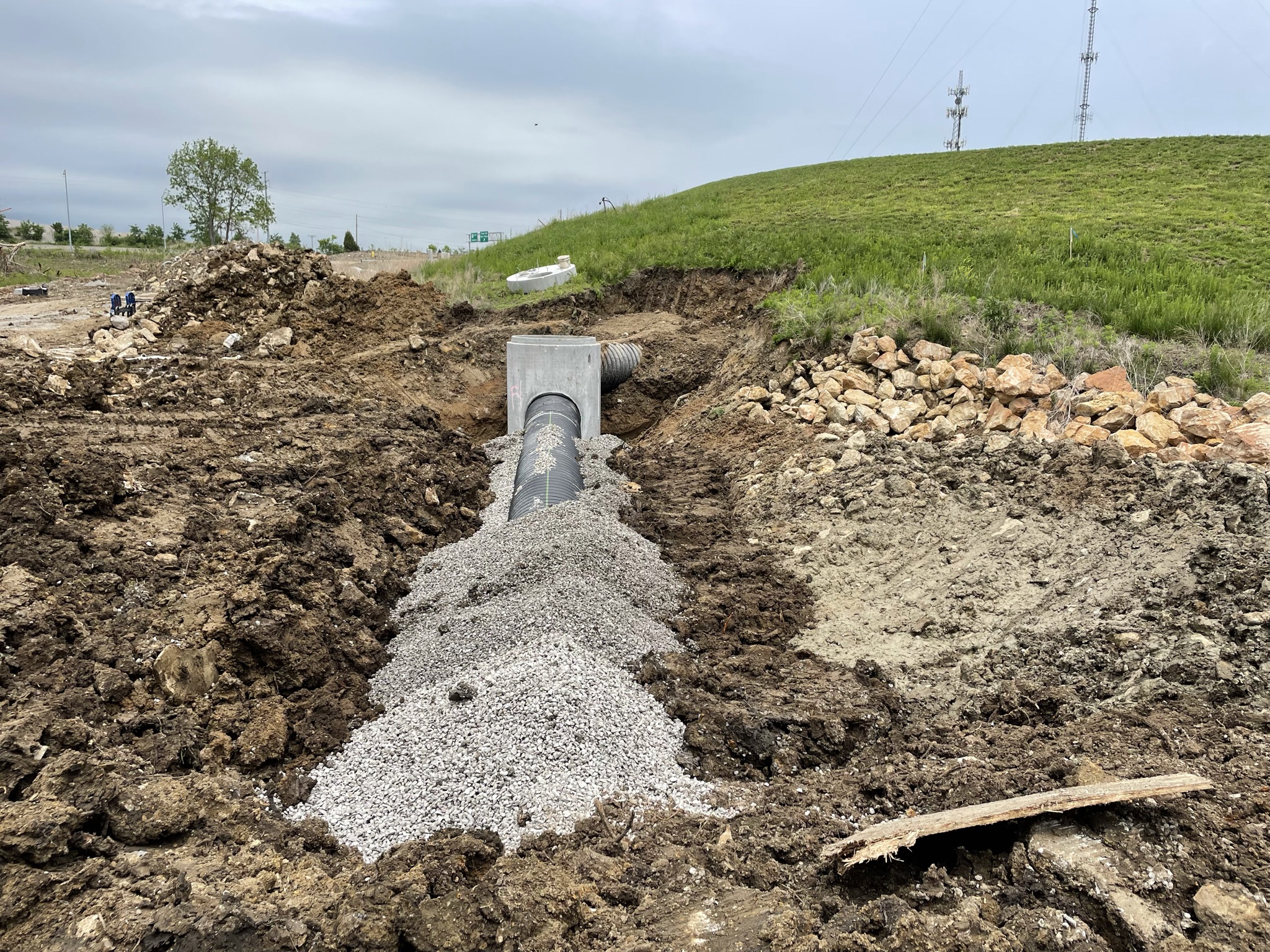

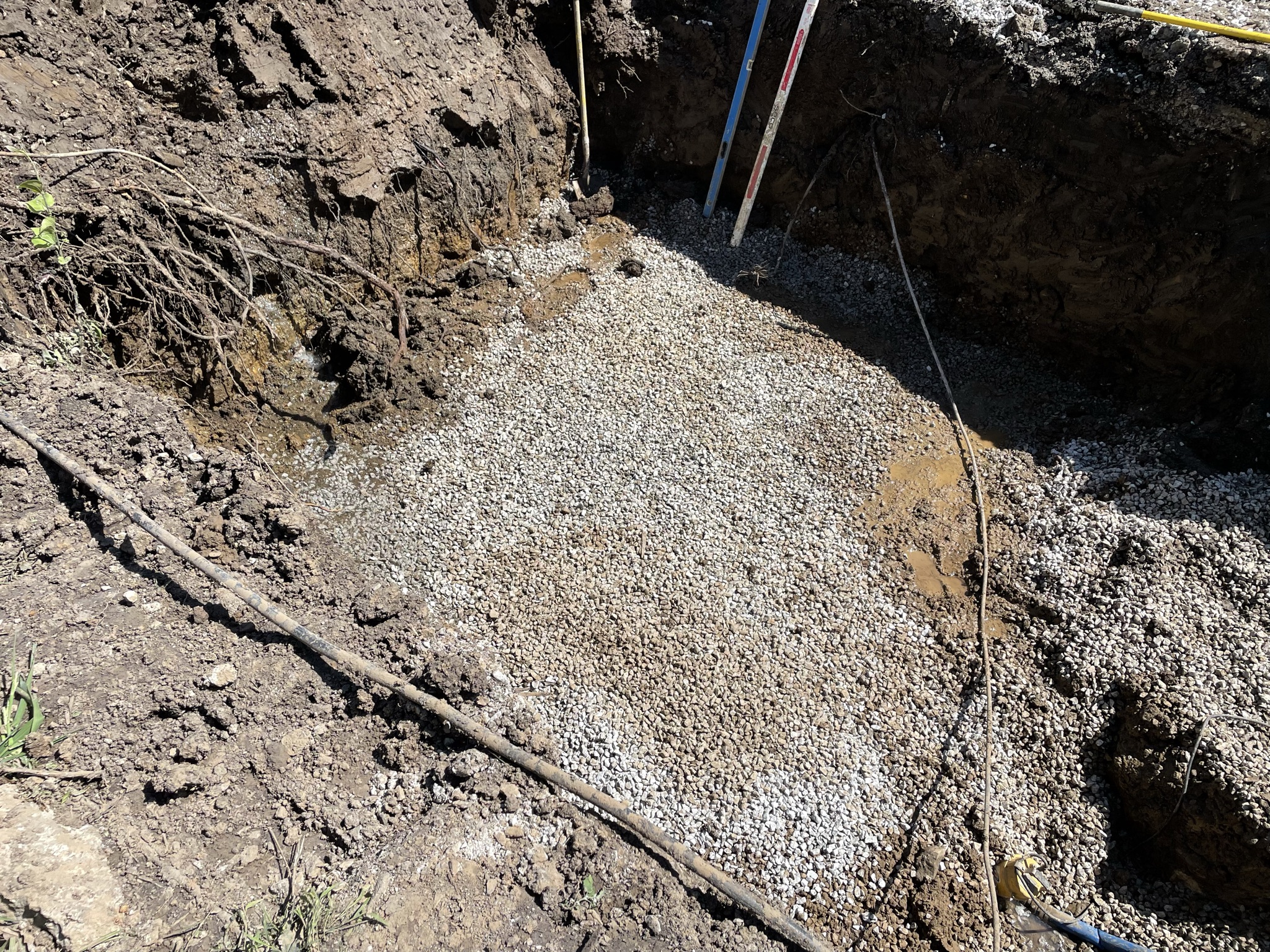

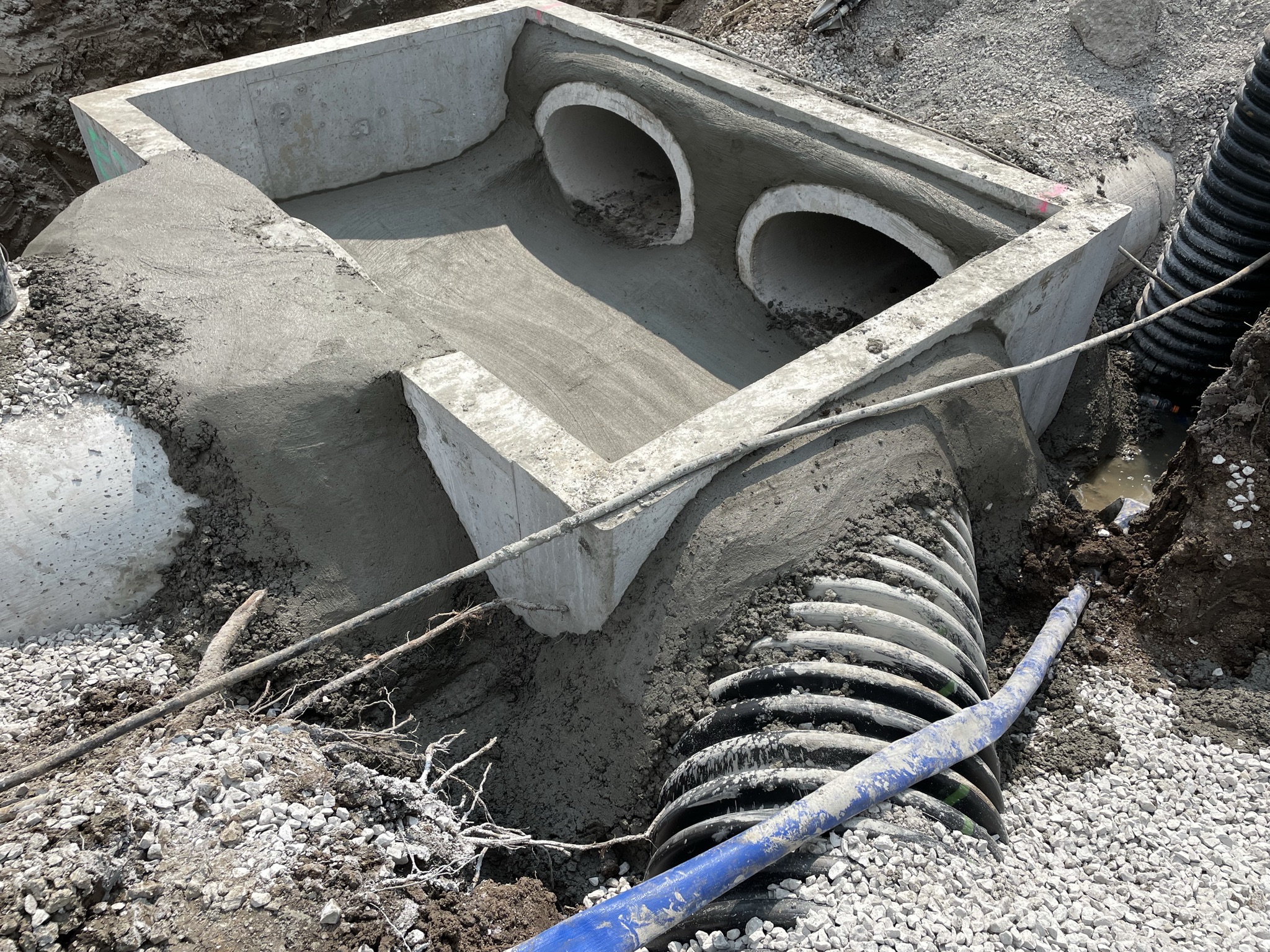

Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022

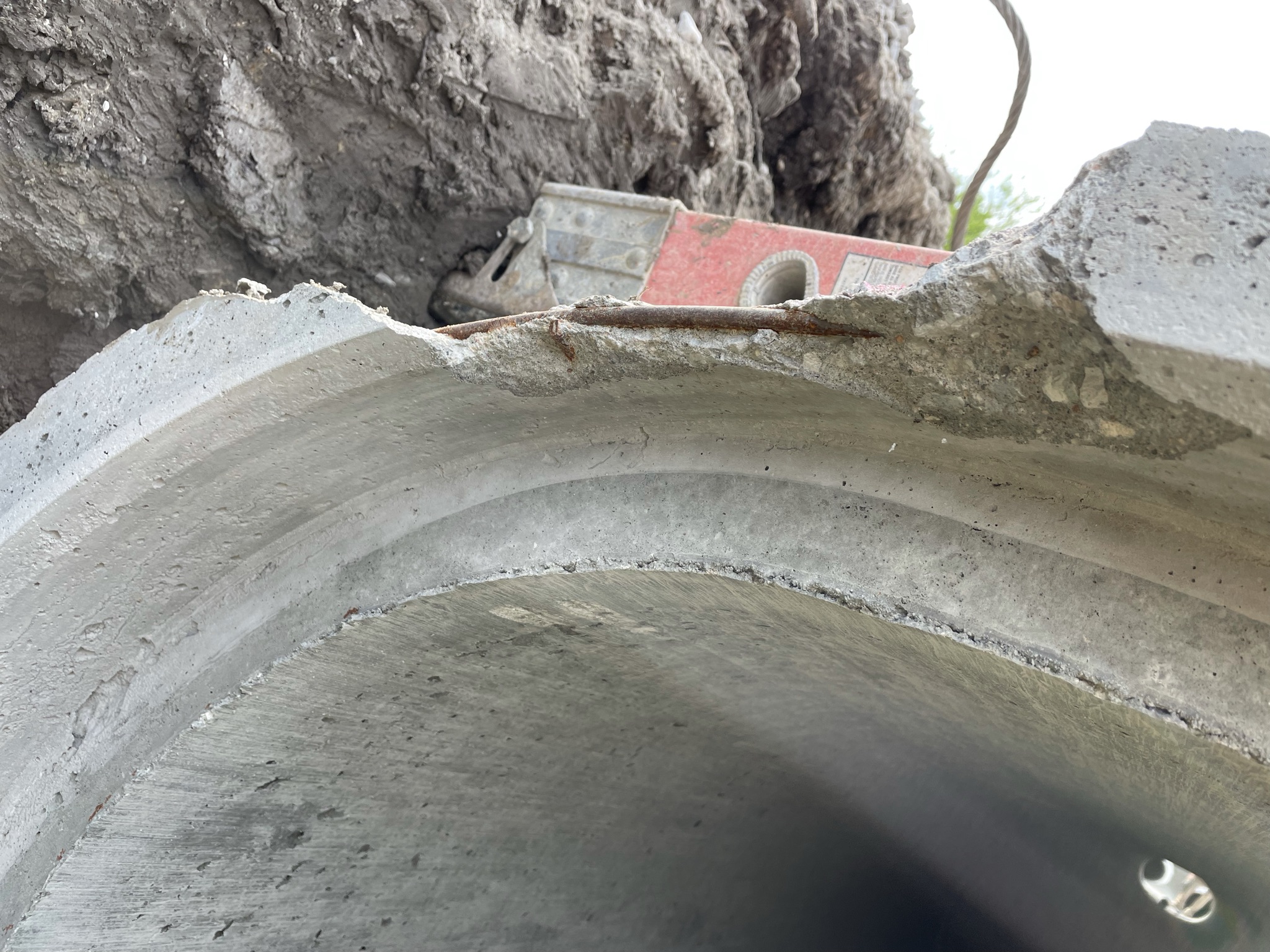

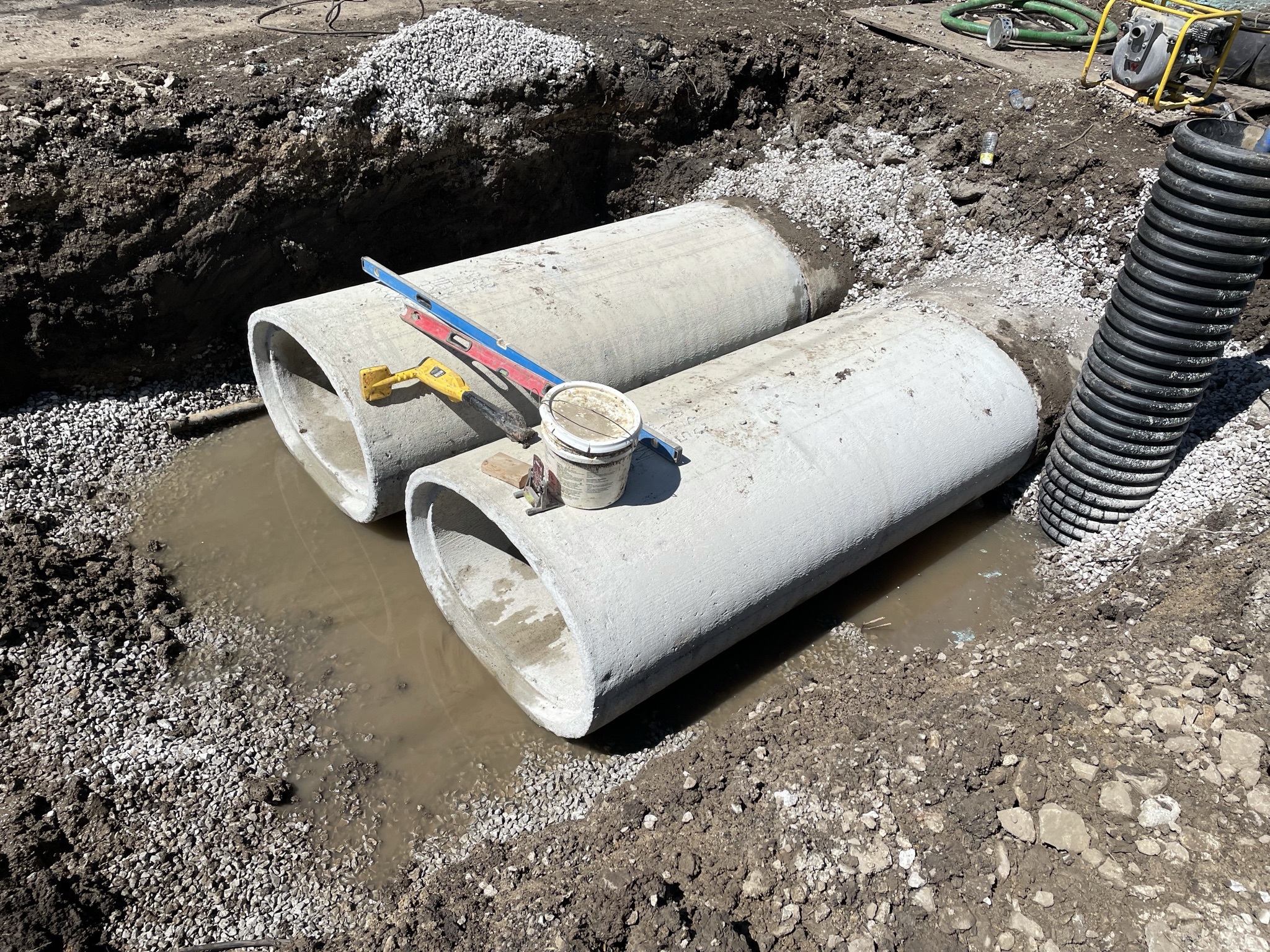

Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022

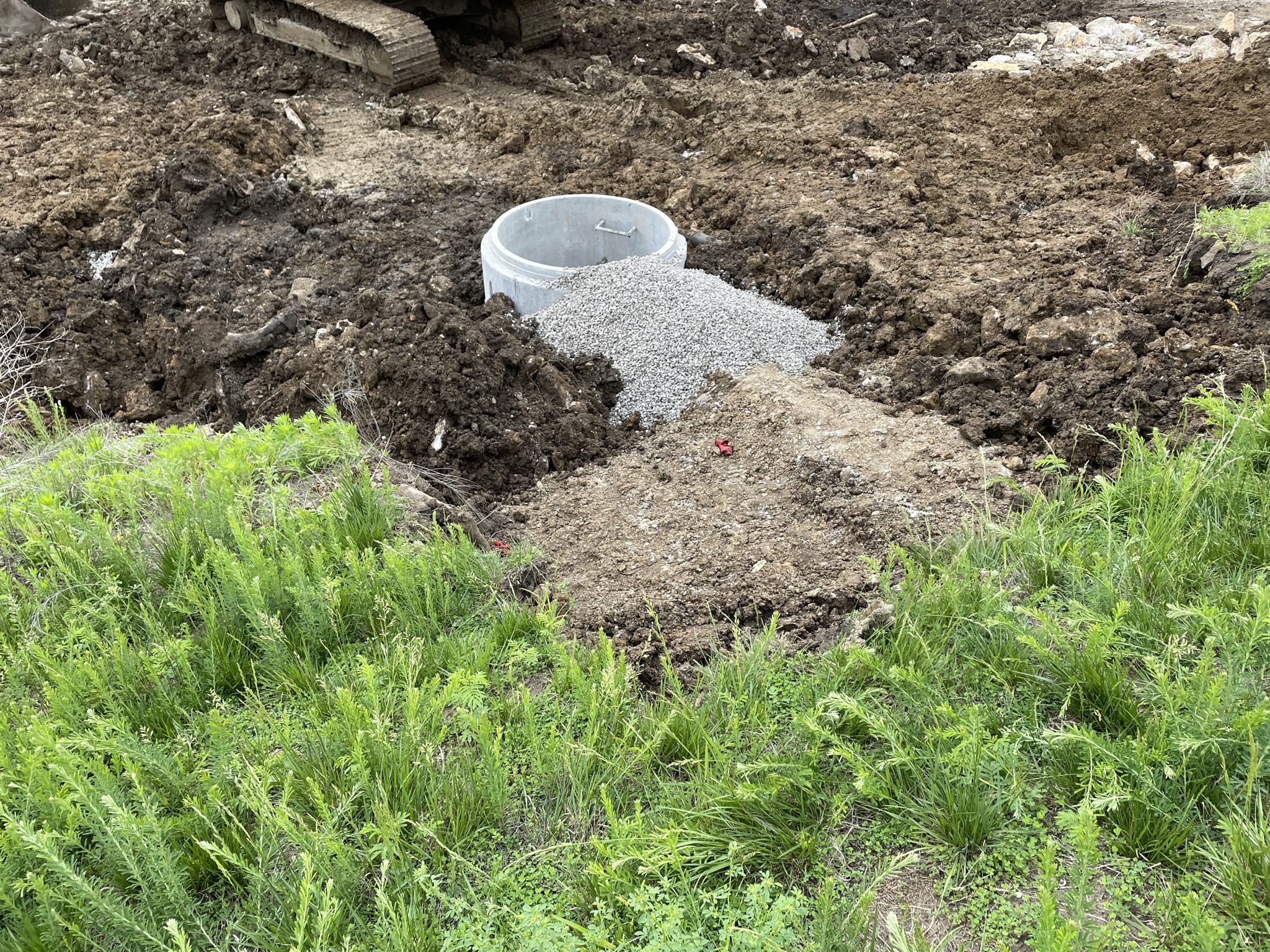

Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022

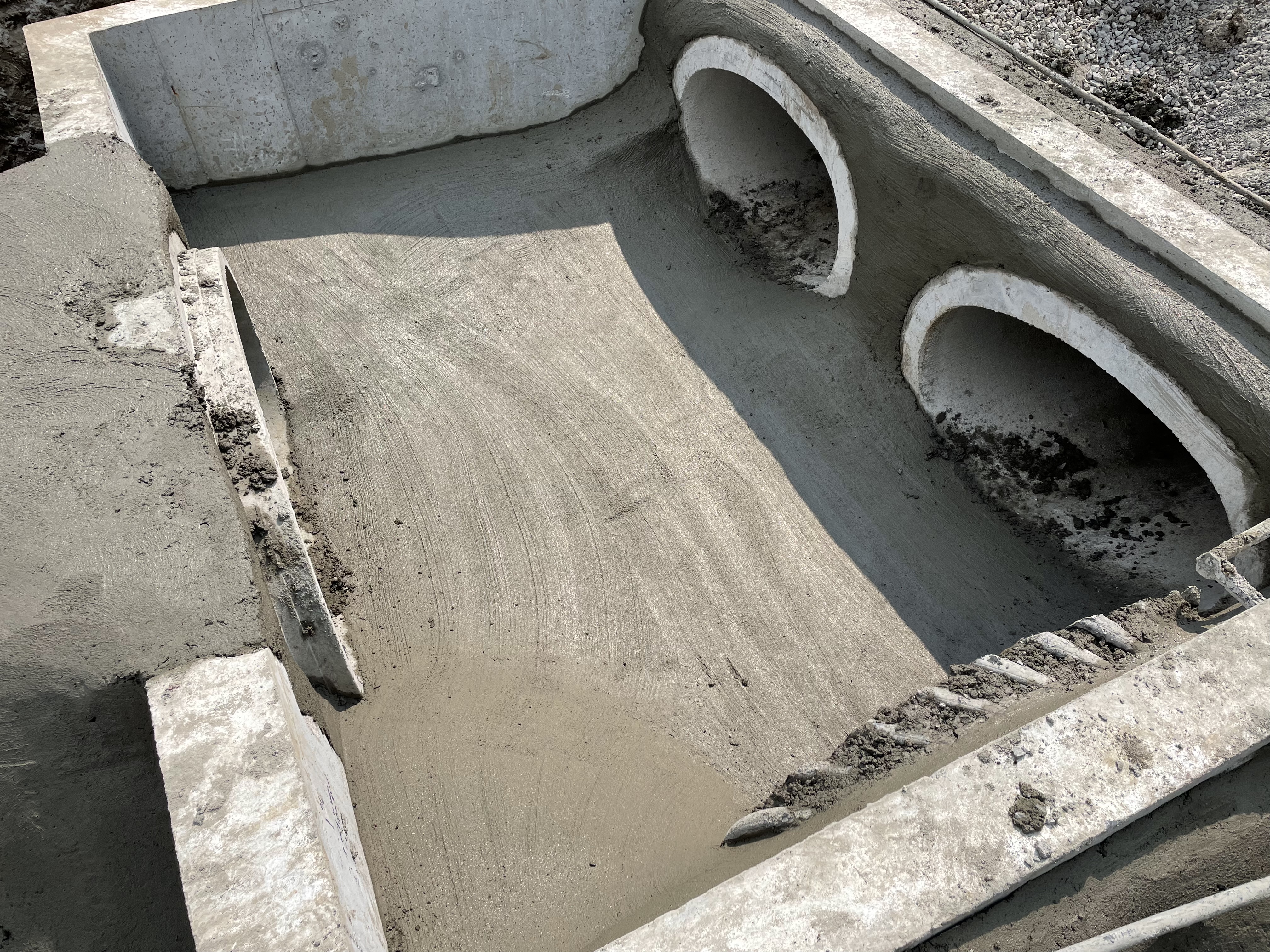

Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022

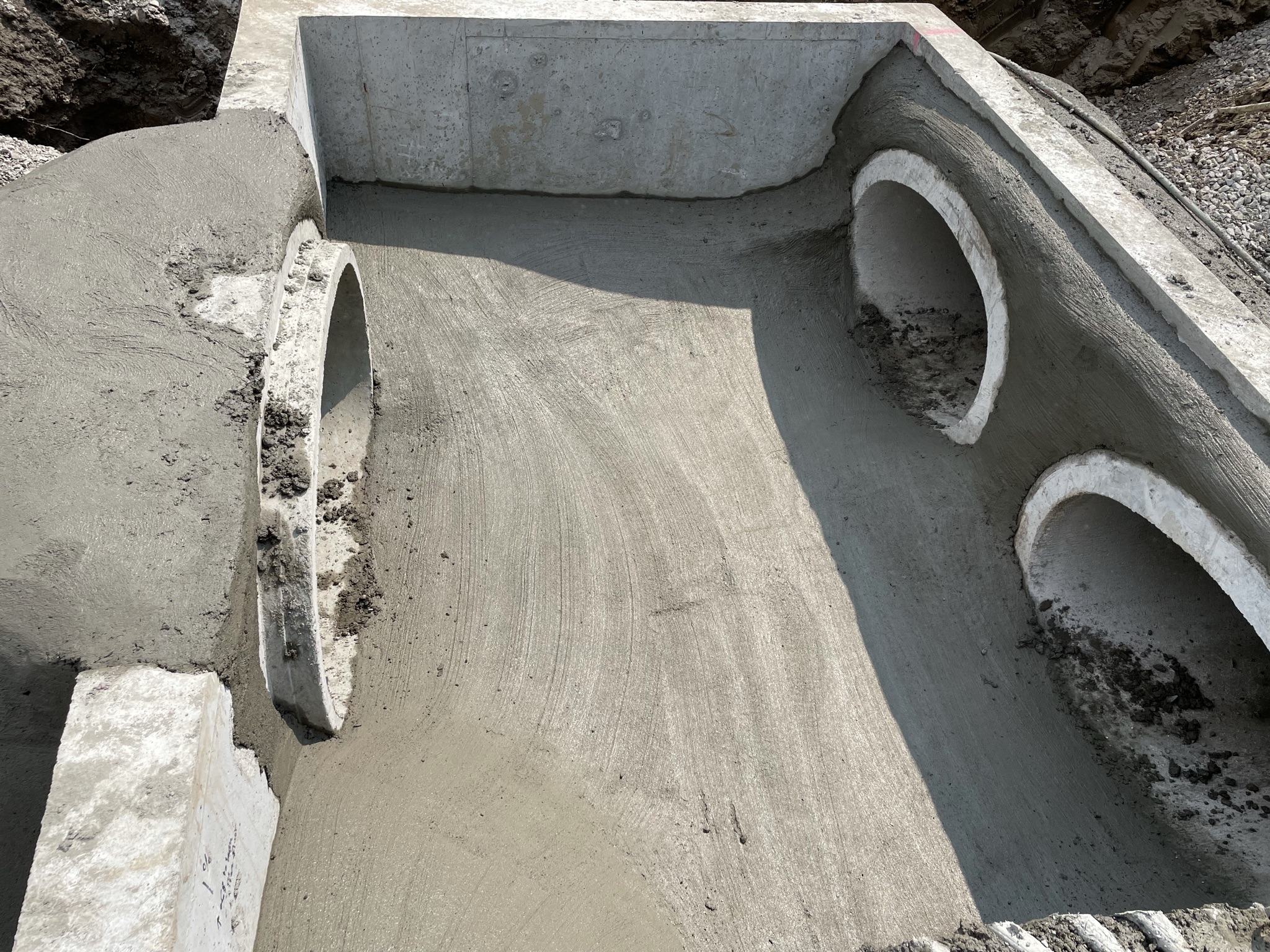

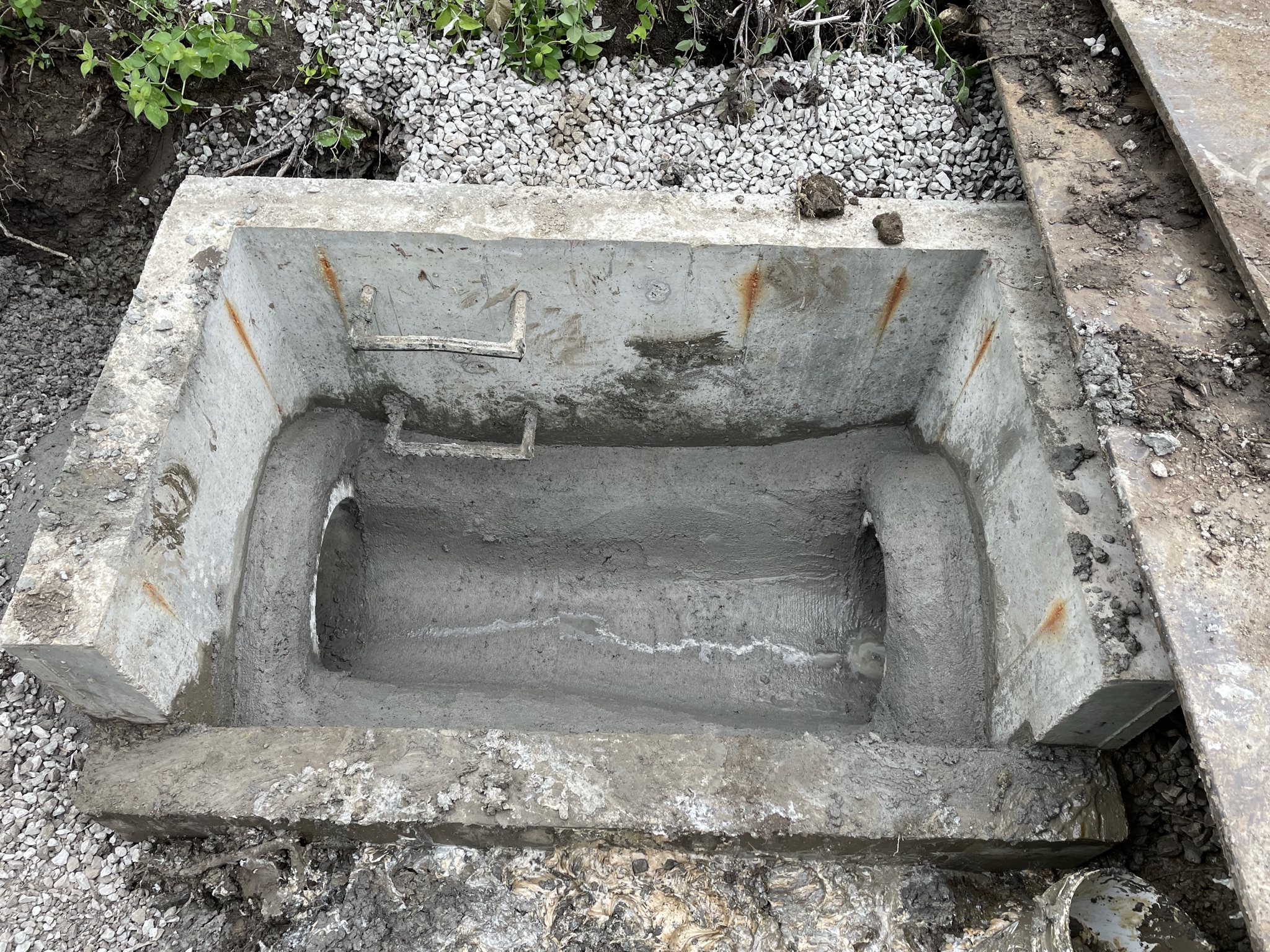

Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022

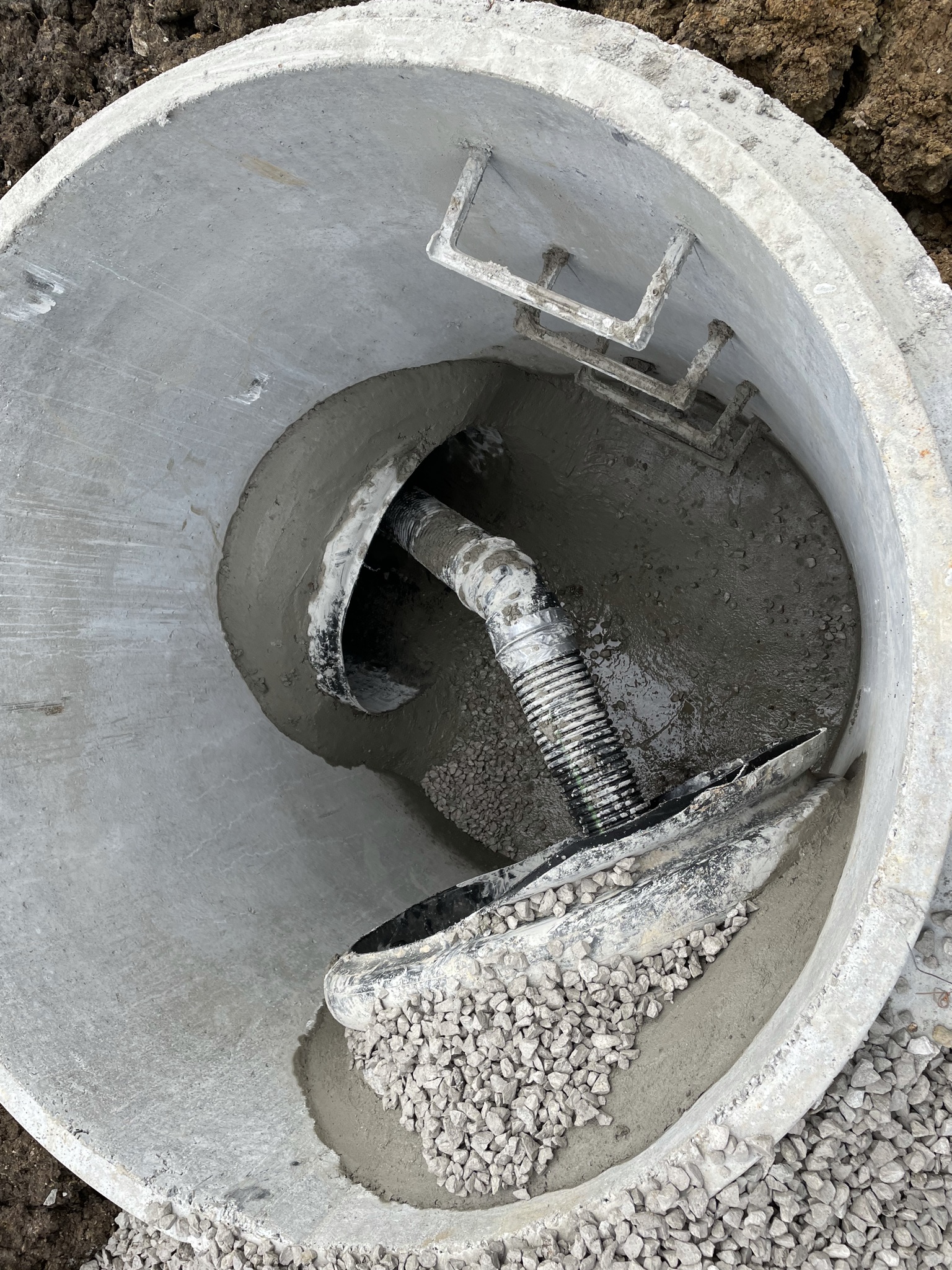

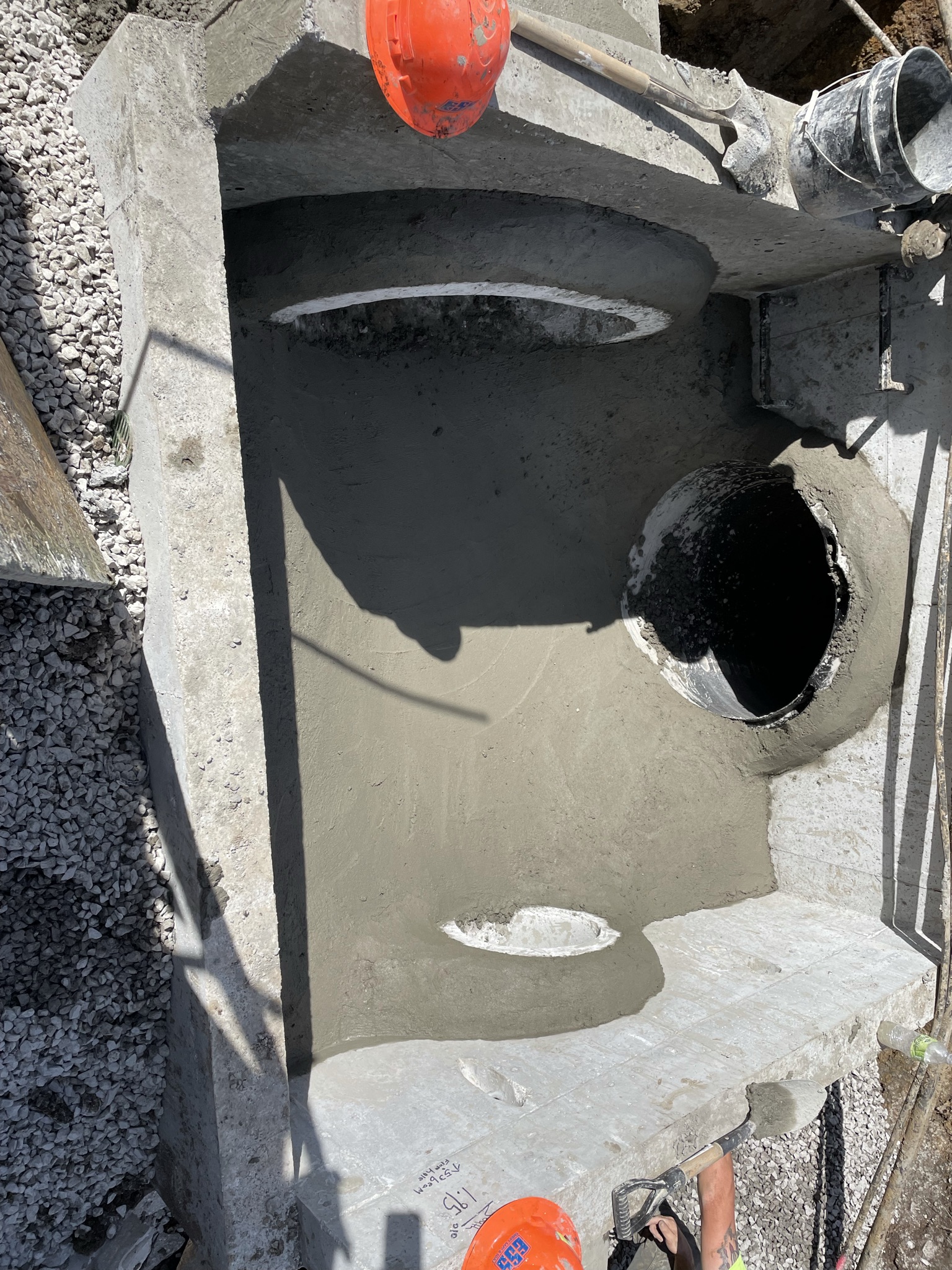

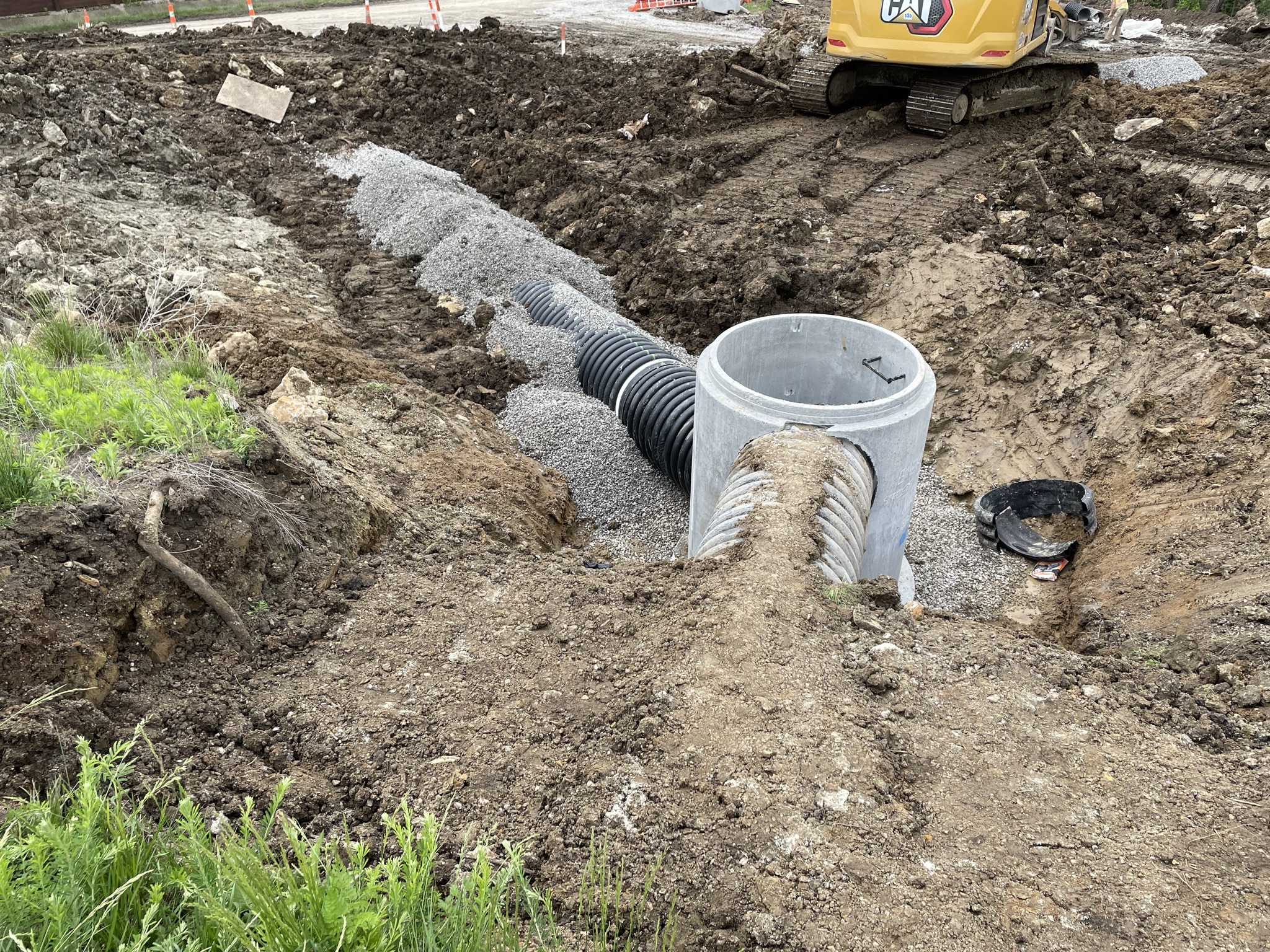

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022

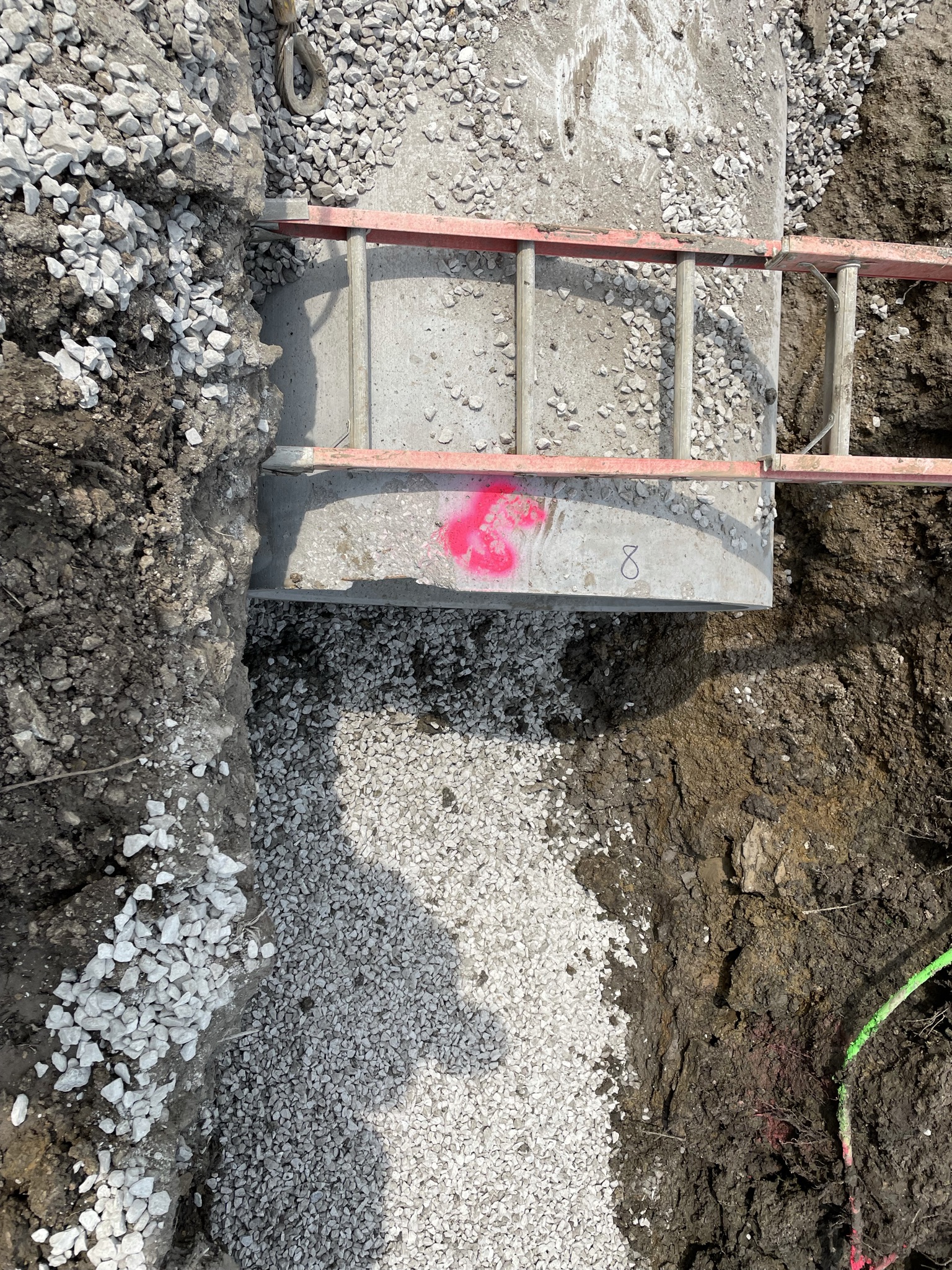

Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES
Misc
Corrective Action Required
05/12/2022
5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022

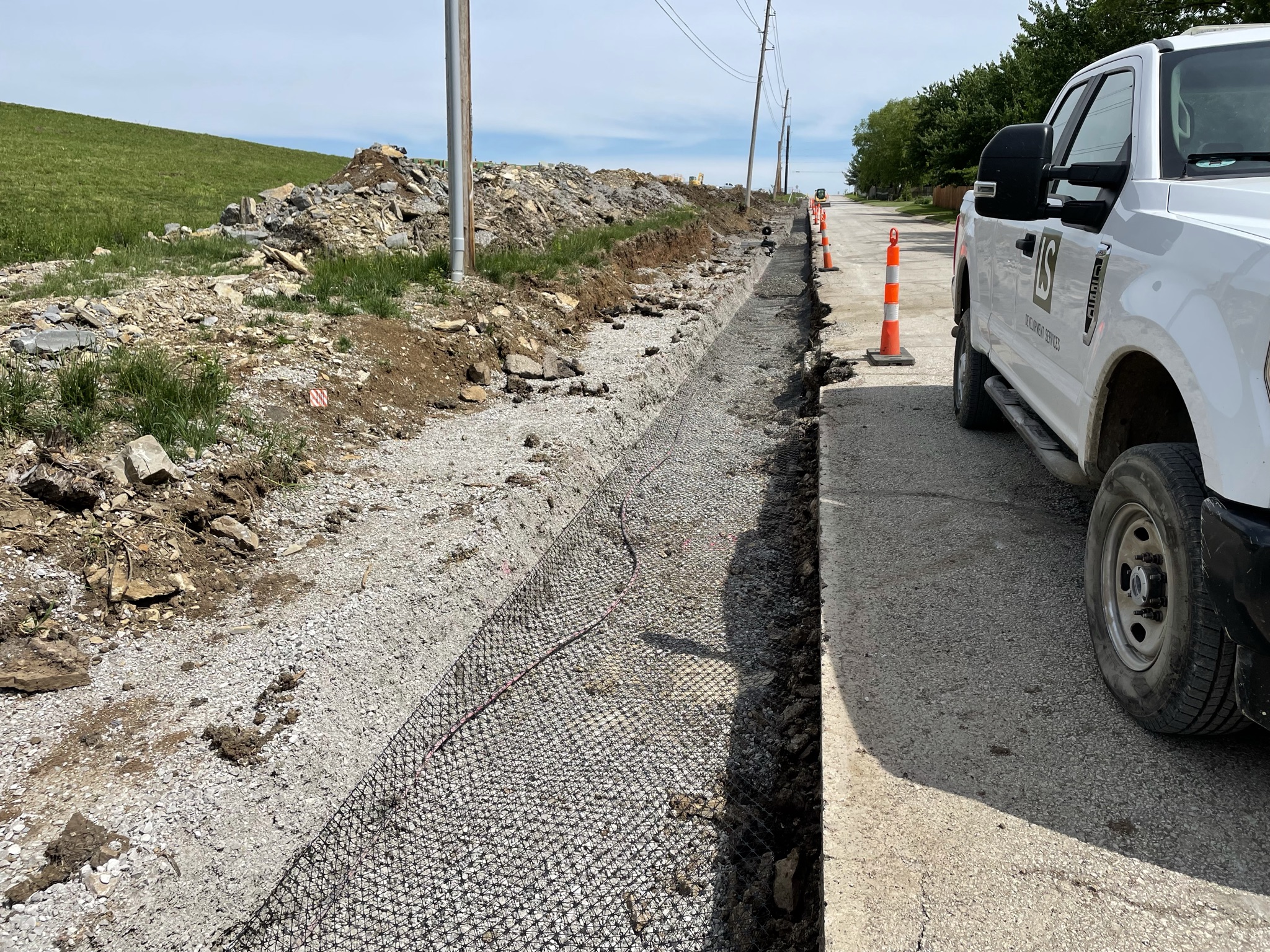

5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed
Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/12/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES
Misc
Corrective Action Required
05/12/2022
5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed
Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/12/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/12/2022
5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed
Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/12/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/12/2022
5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box at the bottom of the hill
Storm Sewer Construction Inspection Partial 05/12/2022
Misc
Informational
05/12/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/12/2022
5-12-22 AN crew was pouring collars and inverts on the storm box at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box at the bottom of the hill

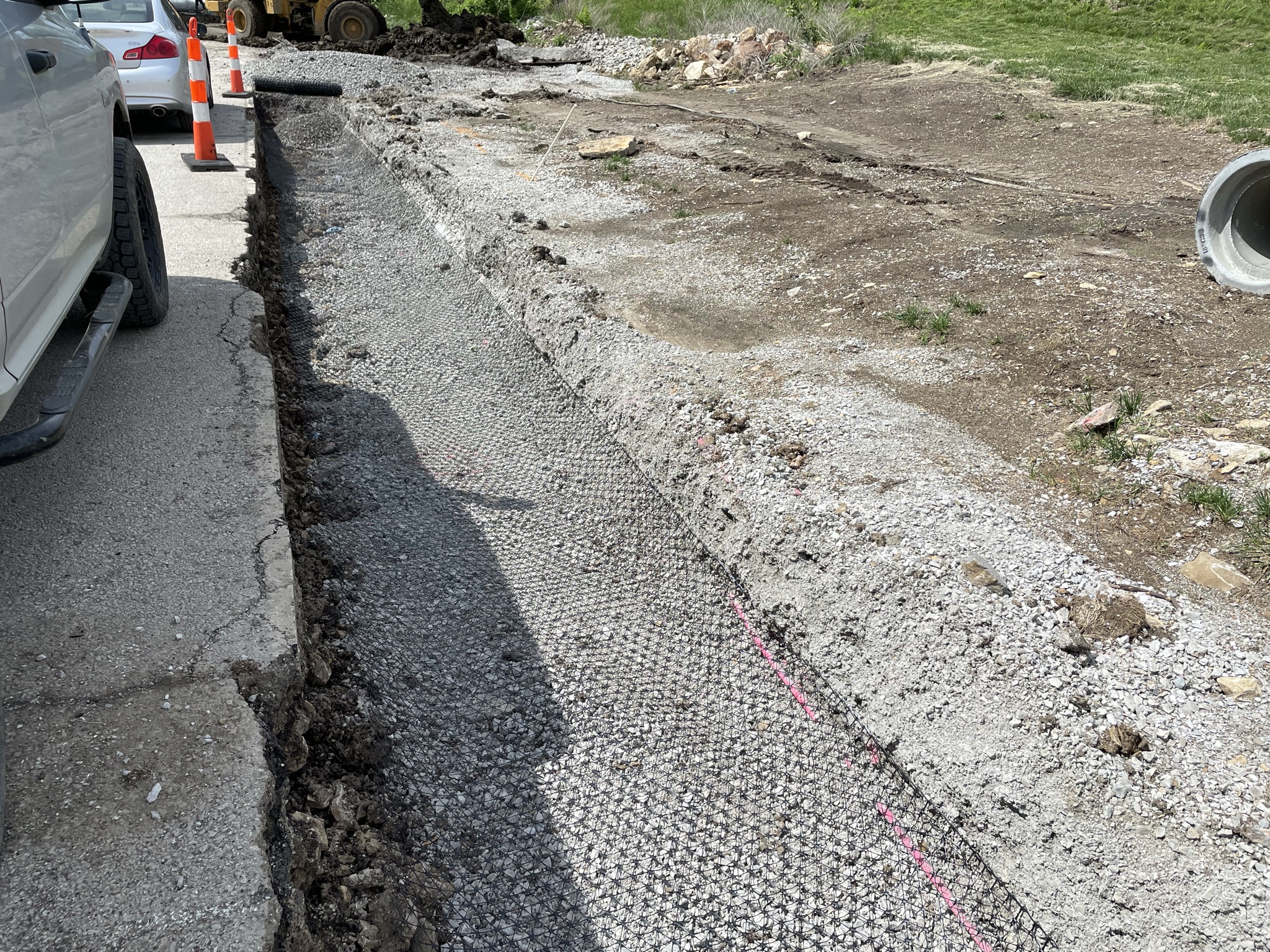

Storm Sewer Construction Inspection Partial 05/17/2022
Misc
Informational
05/12/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/12/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/12/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/12/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/12/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/12/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/12/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/12/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/12/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/12/2022

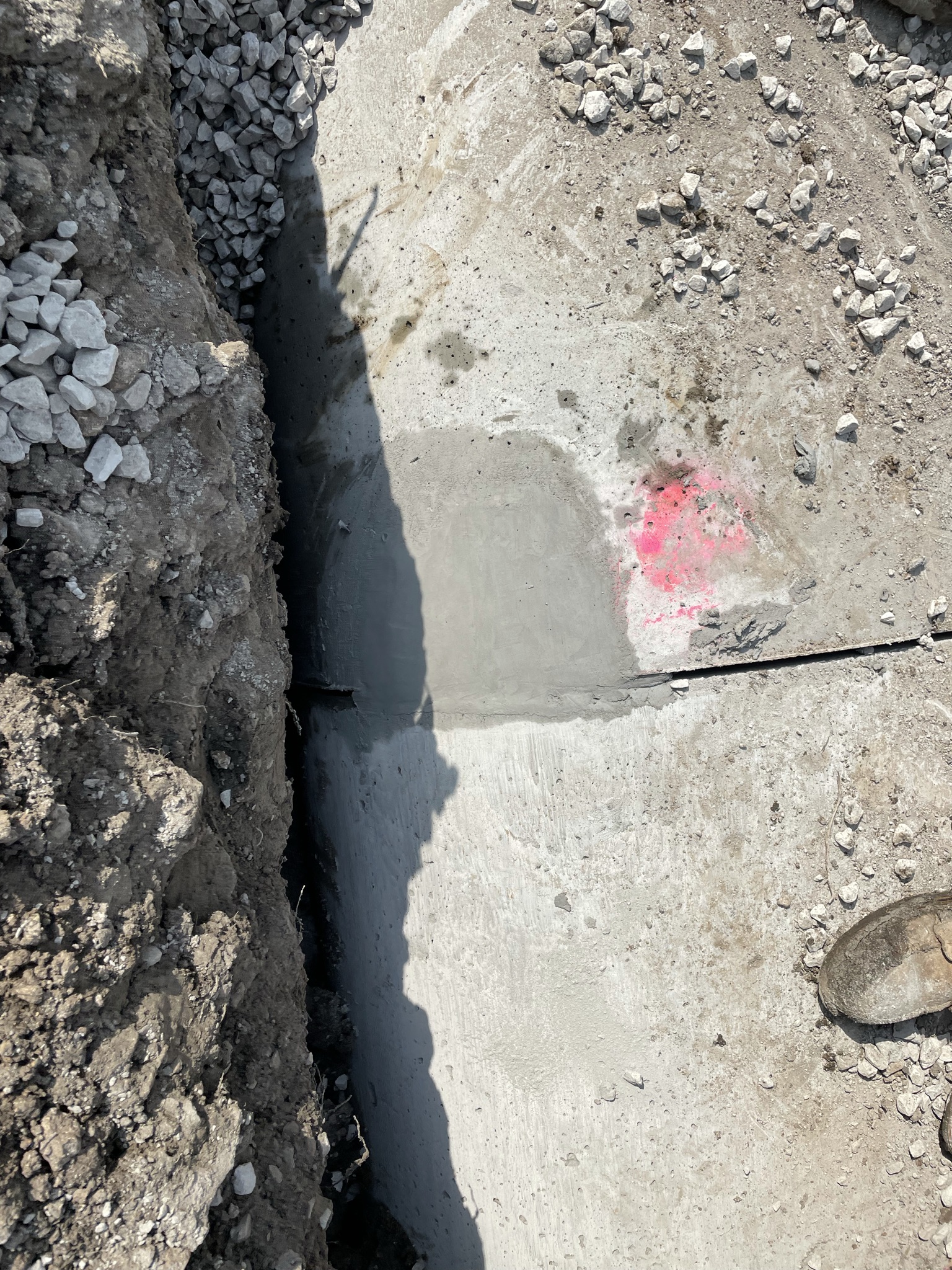

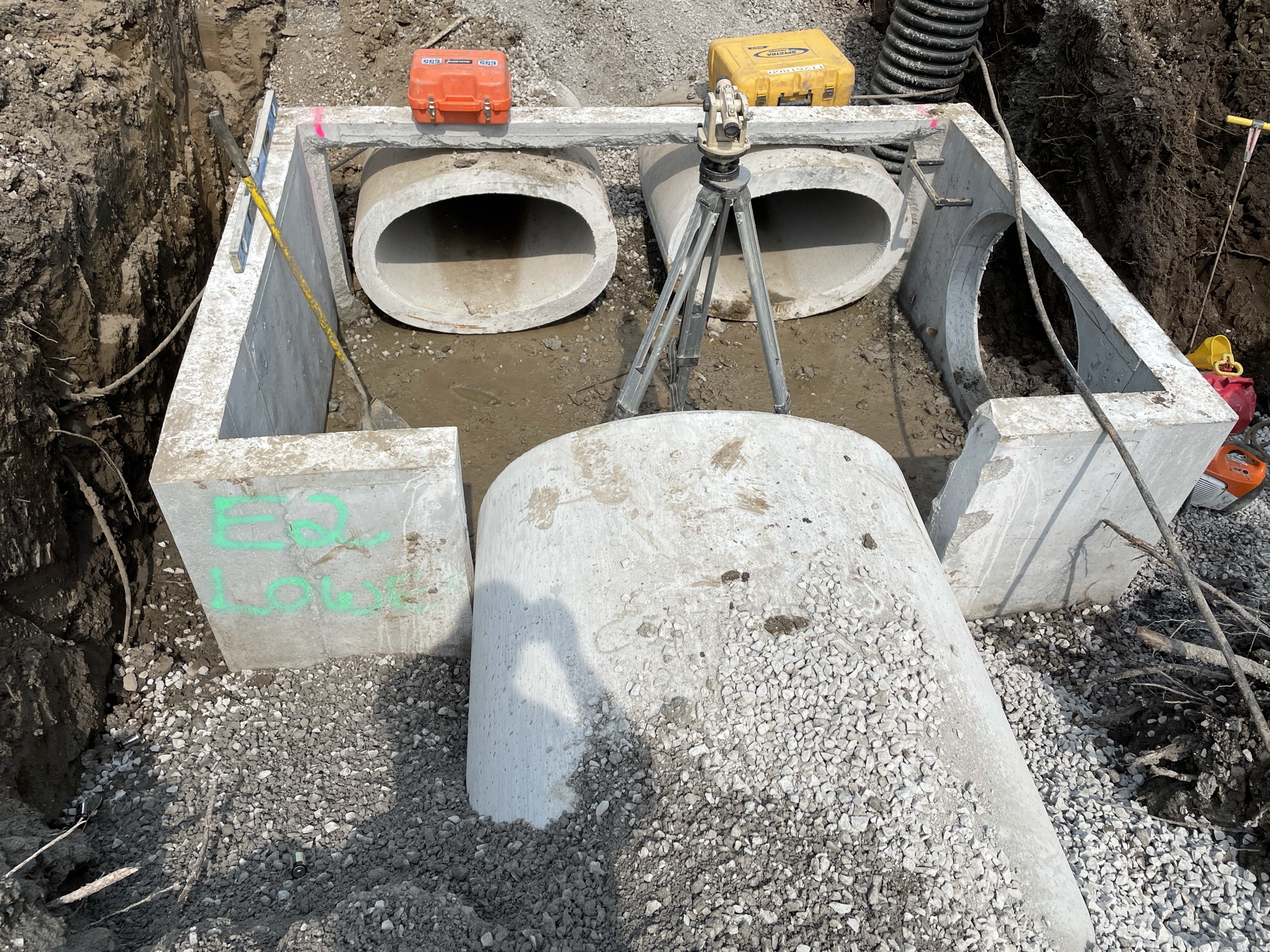

5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/12/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/17/2022

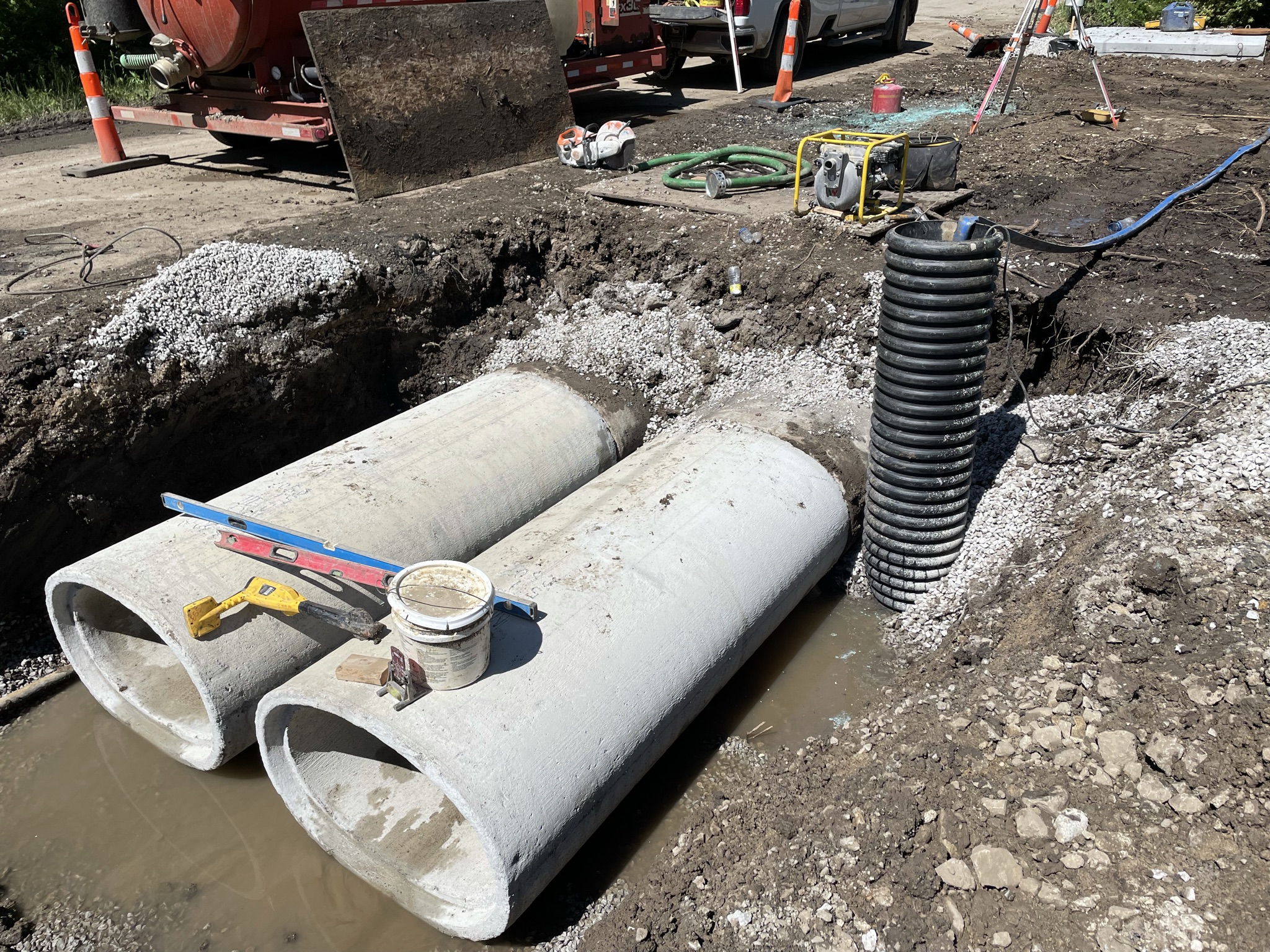

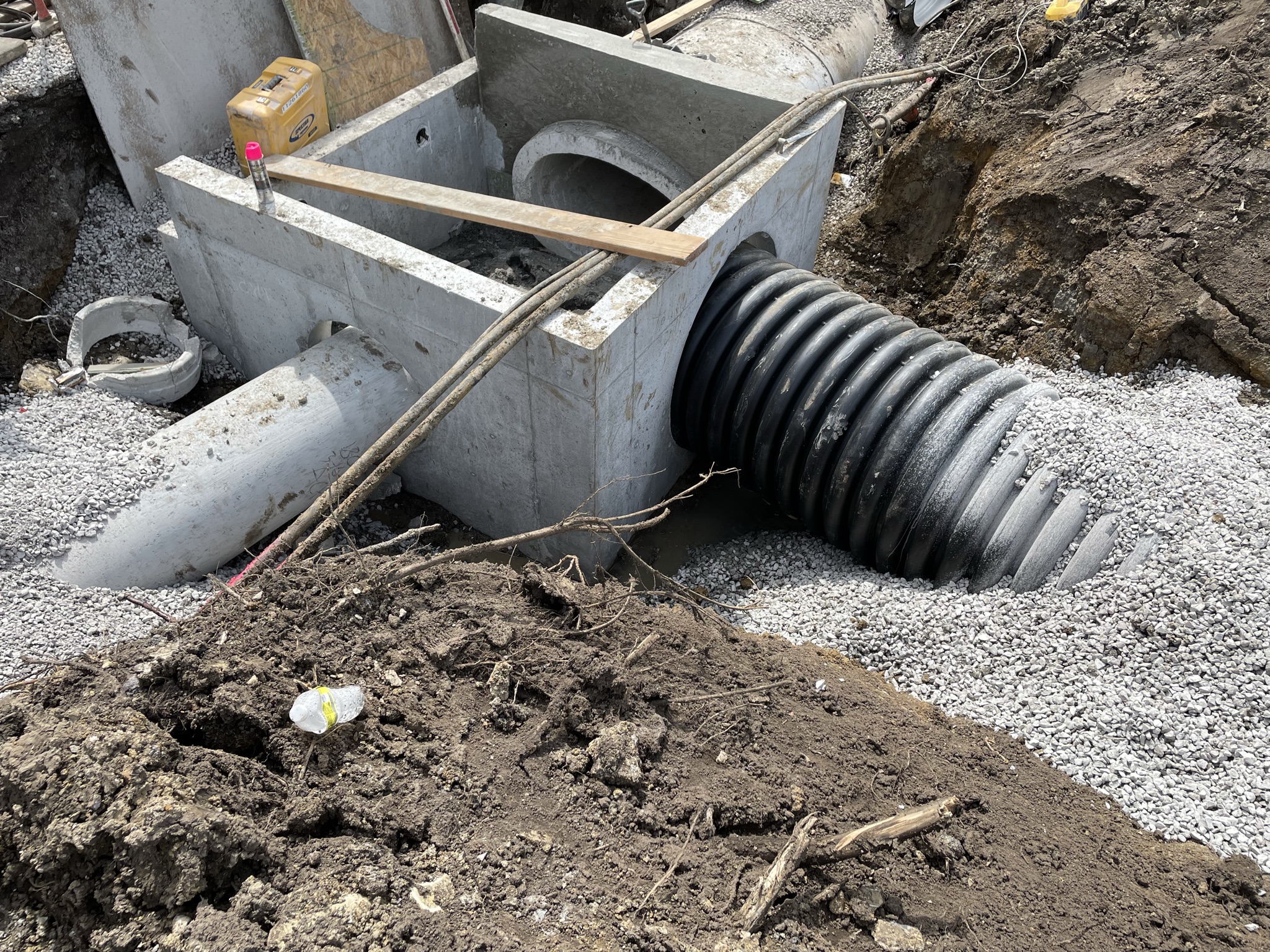

Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Storm Sewer Construction Inspection Partial 05/17/2022
Misc
Informational
05/17/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/17/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/17/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/17/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/17/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/17/2022

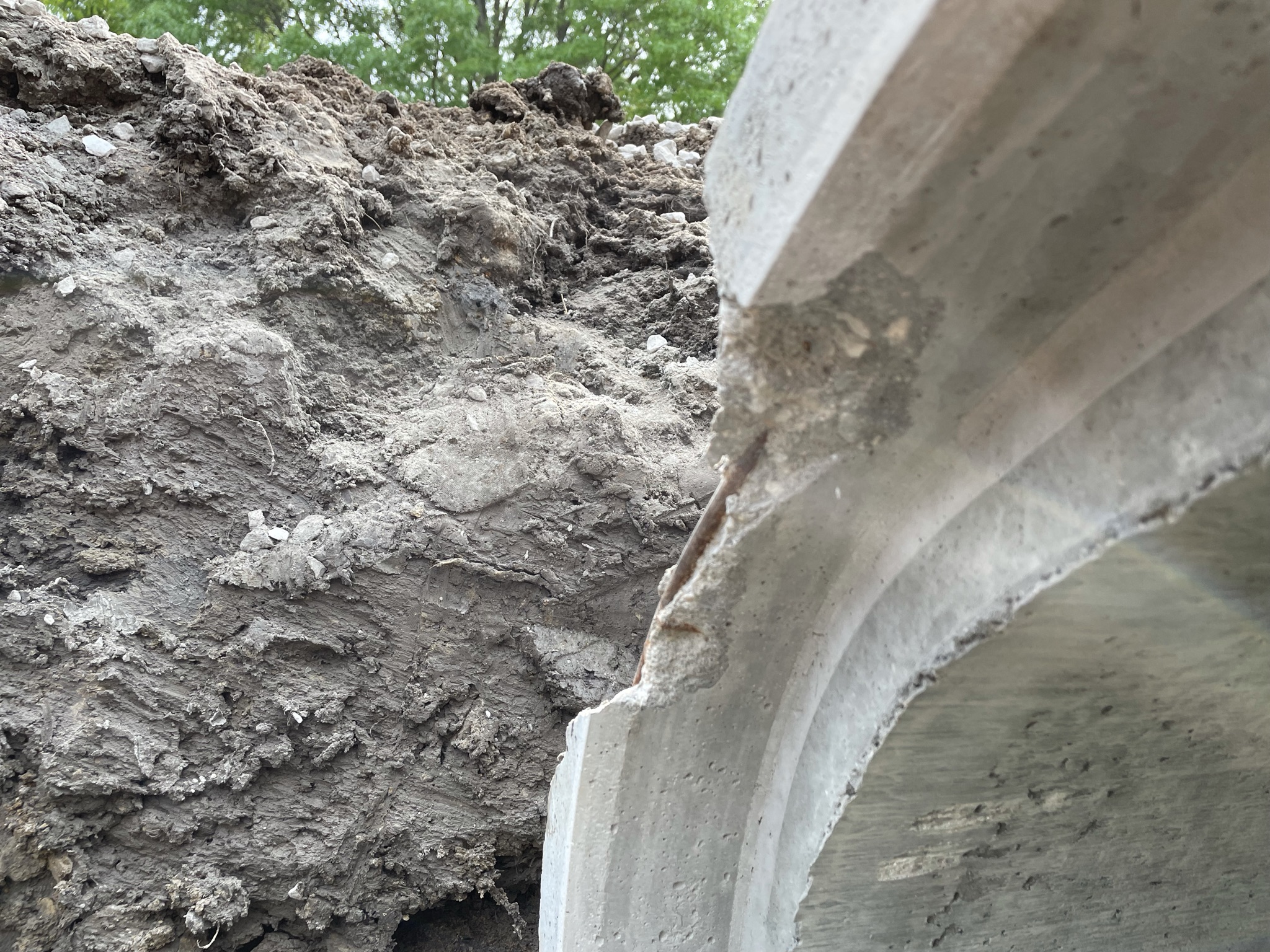

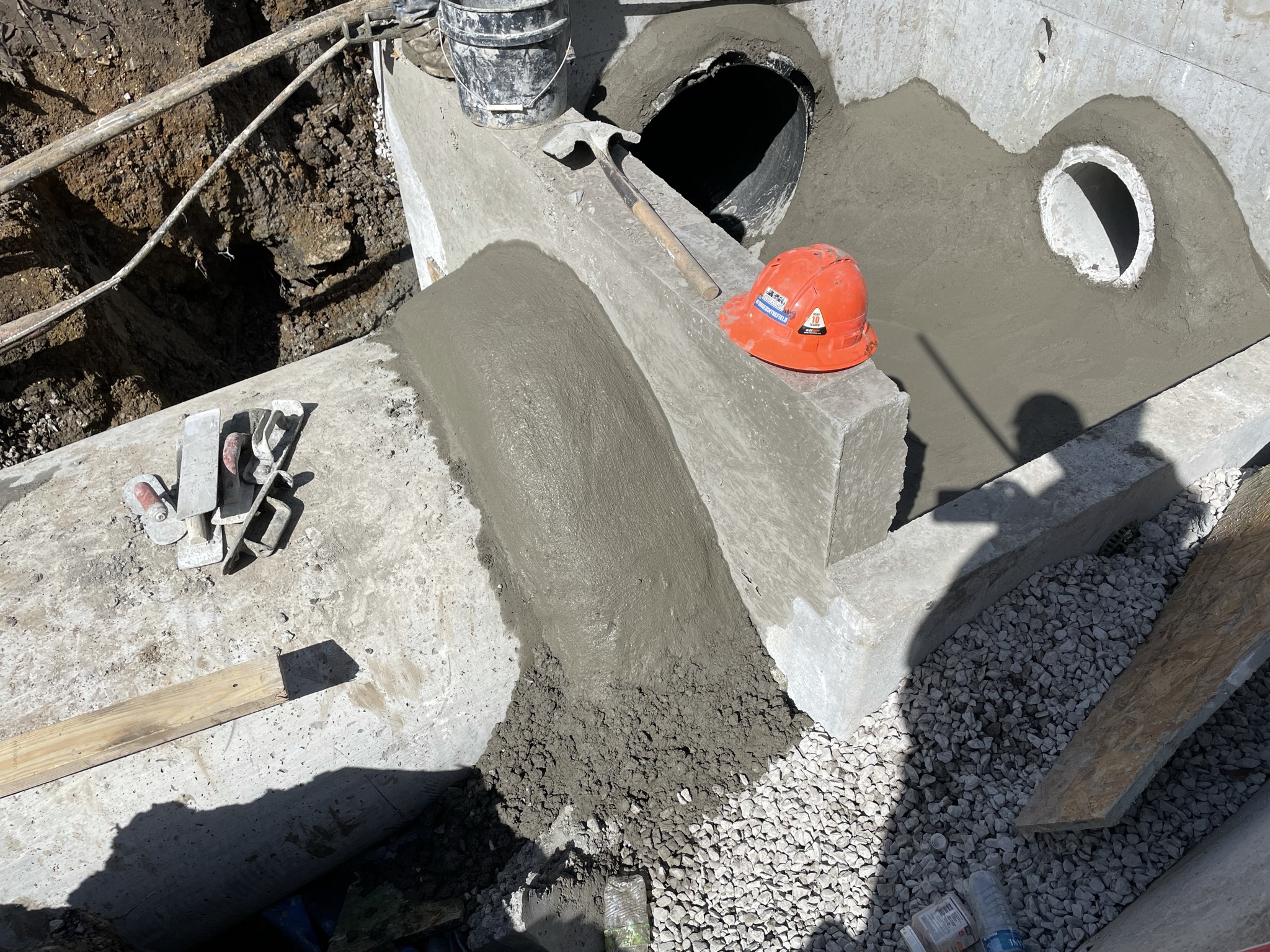

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/17/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/17/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/17/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/17/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/17/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/17/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/17/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/17/2022

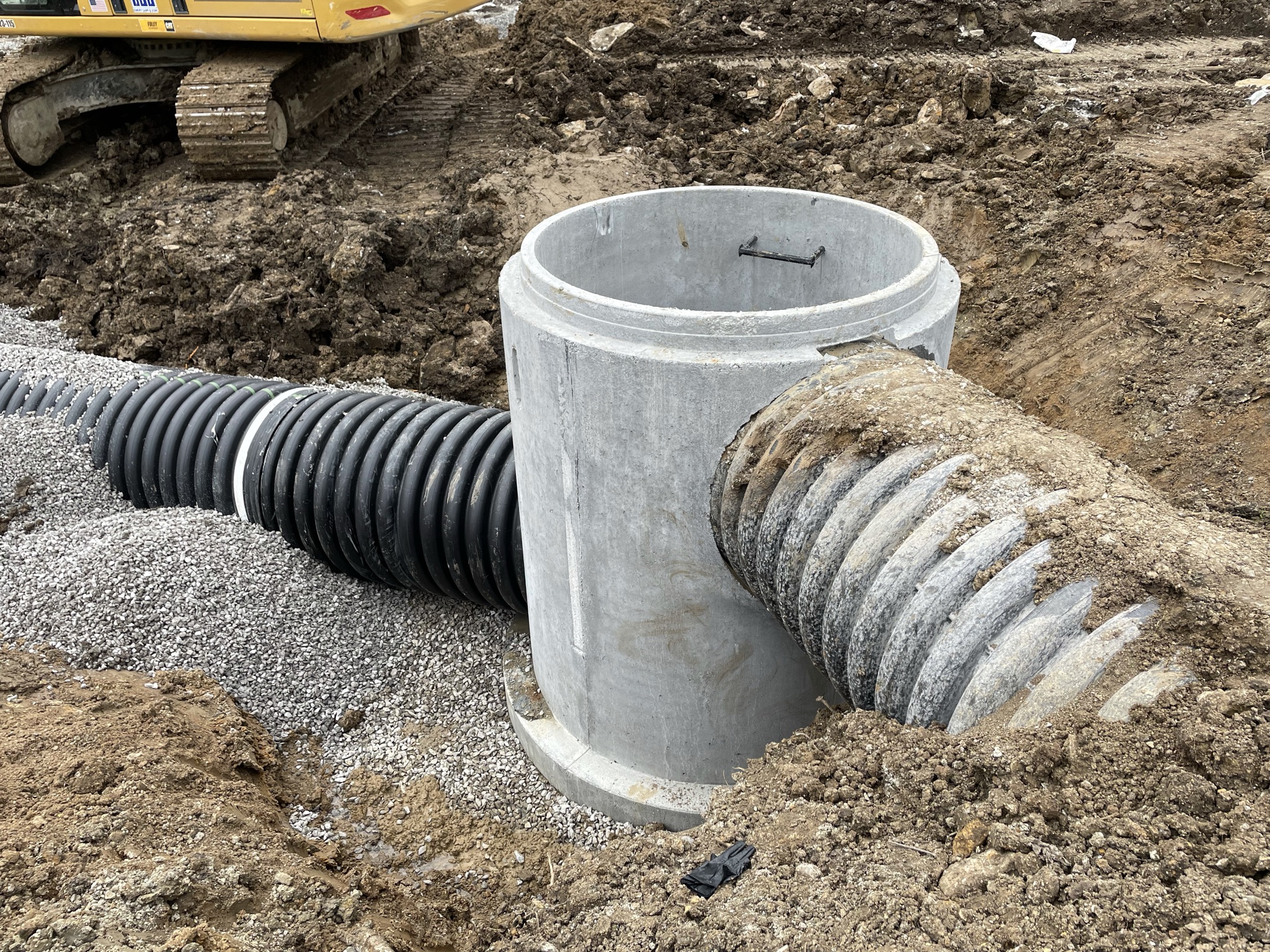

Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES
Storm Sewer Construction Inspection Partial 05/18/2022
Misc
Informational
05/17/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/17/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/17/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/17/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/17/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/17/2022

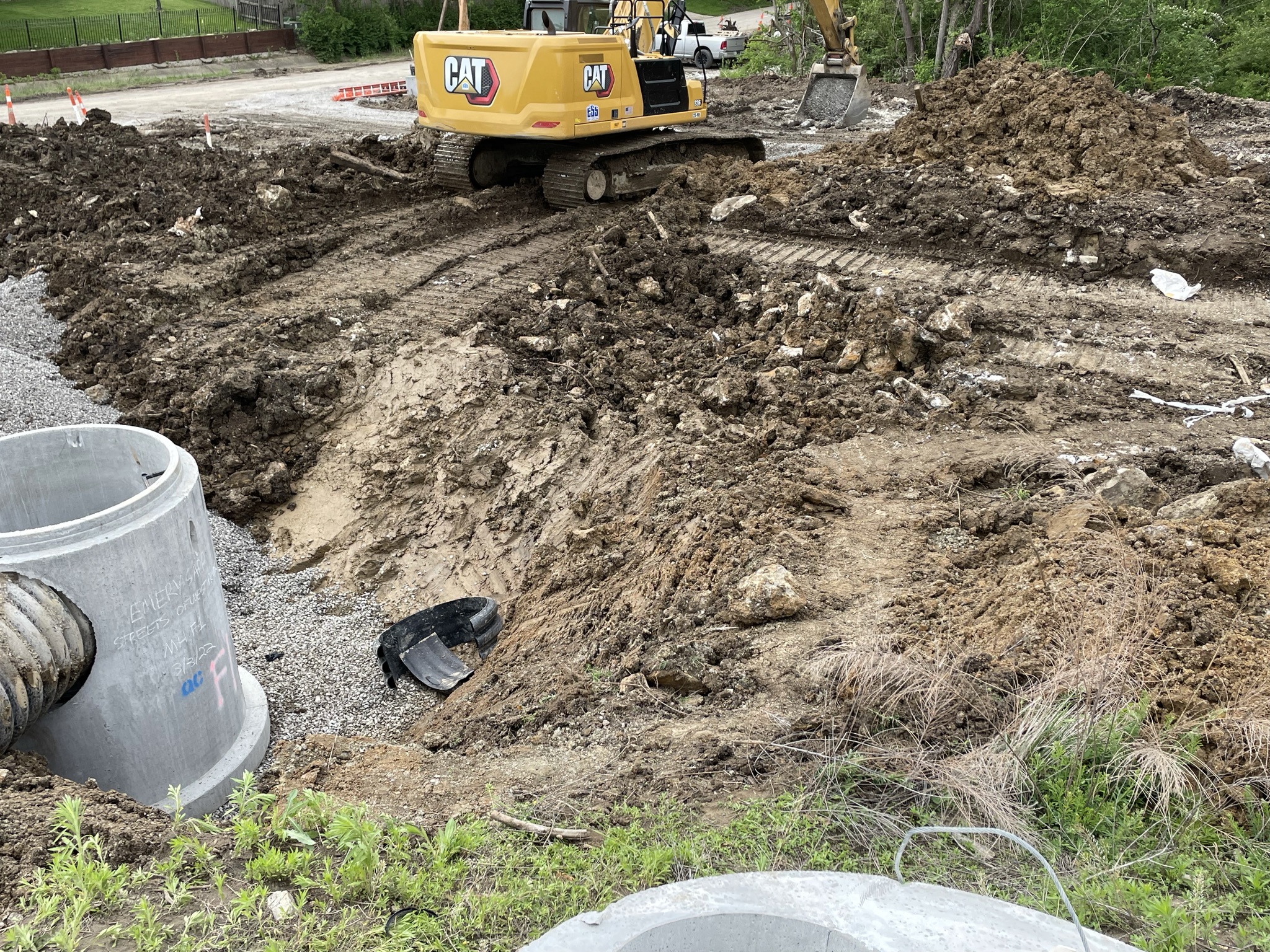

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/17/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/17/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/17/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/17/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/17/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/17/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/17/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/17/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES
Storm Sewer Construction Inspection Partial 05/19/2022
Misc
Informational
05/18/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/18/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/18/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/18/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/18/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/18/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/18/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/18/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/18/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/18/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/18/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/18/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/18/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/18/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES
Storm Sewer Construction Inspection Partial 05/19/2022
Misc
Informational
05/19/2022

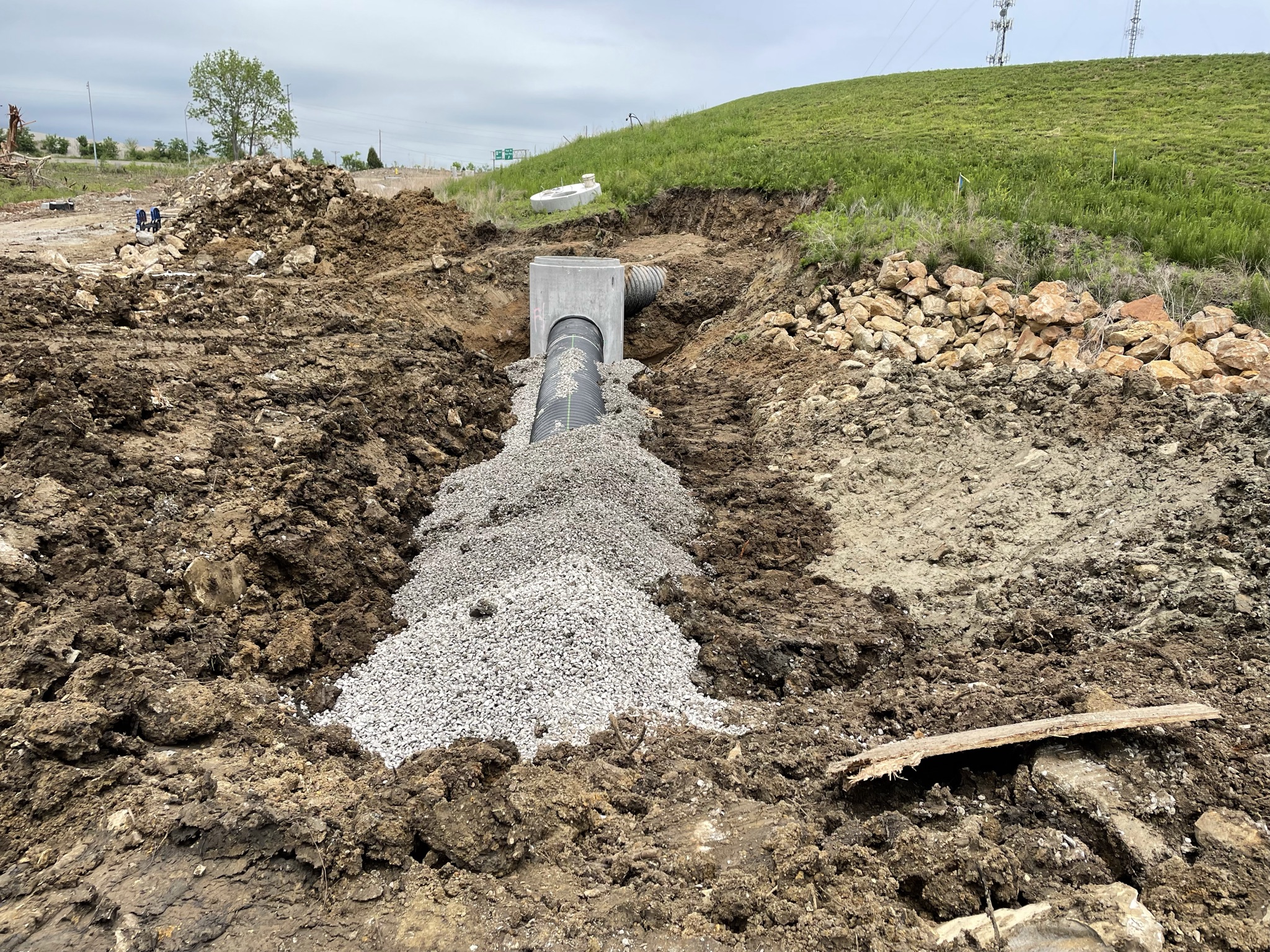

Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/19/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/19/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/19/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/19/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/19/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/19/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/19/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/19/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/19/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/19/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/19/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/19/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/19/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES
Storm Sewer Construction Inspection Partial 05/23/2022
Misc
Informational
05/19/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/19/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/19/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/19/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/19/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/19/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/19/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/19/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/19/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/19/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/19/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/19/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/19/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/19/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES
Storm Sewer Construction Inspection Partial 05/23/2022
Misc
Informational
05/23/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/23/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/23/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/23/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/23/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/23/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/23/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/23/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/23/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/23/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/23/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/23/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES
Storm Sewer Construction Inspection Partial 05/23/2022
Misc
Informational
05/23/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/23/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/23/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/23/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/23/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/23/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/23/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/23/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/23/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/23/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/23/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/23/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Site Visit Partial 05/31/2022
Misc
Informational
04/28/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
04/28/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
04/28/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
04/28/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
04/28/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
04/28/2022
No work being performed today. 4/28/22 ES
Misc
Informational
05/03/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES

Pavement-Curb Construction Partial 05/31/2022
Misc
Informational
05/31/2022
ESS crew has been onsite working on base for curbs. Using Geo-grid and aggregate. 5/21/22 ES
Misc
Informational
05/31/2022
No work being done today. Some washout areas in already aggregate layers. 5/31/22 ES
Pavement-Curb Construction Partial 06/03/2022
Misc
Informational
06/03/2022
ESS crew working on base for curb line. 6/3/22 ES
Grading/Excavation/Fill Inspection Partial 06/06/2022
Misc
Informational
06/06/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES
Site Visit Partial 06/06/2022
Misc
Informational
05/31/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
05/31/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
05/31/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
05/31/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
05/31/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/31/2022
No work being performed today. 4/28/22 ES
Misc
Informational
05/31/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES
Grading/Excavation/Fill Inspection Partial 06/07/2022
Misc
Informational
06/06/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES
Site Visit Partial 06/07/2022
Misc
Informational
06/06/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/06/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/06/2022

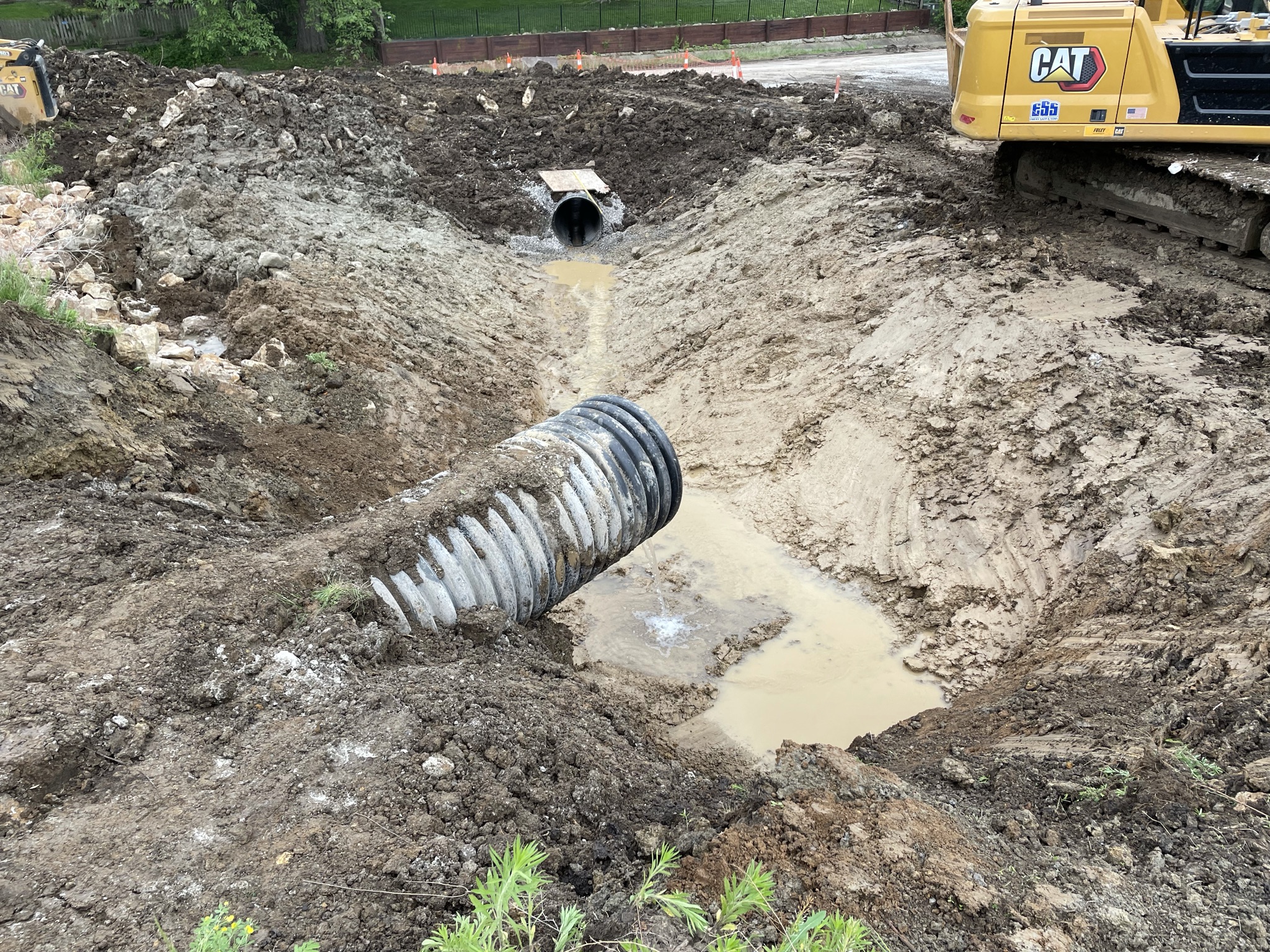

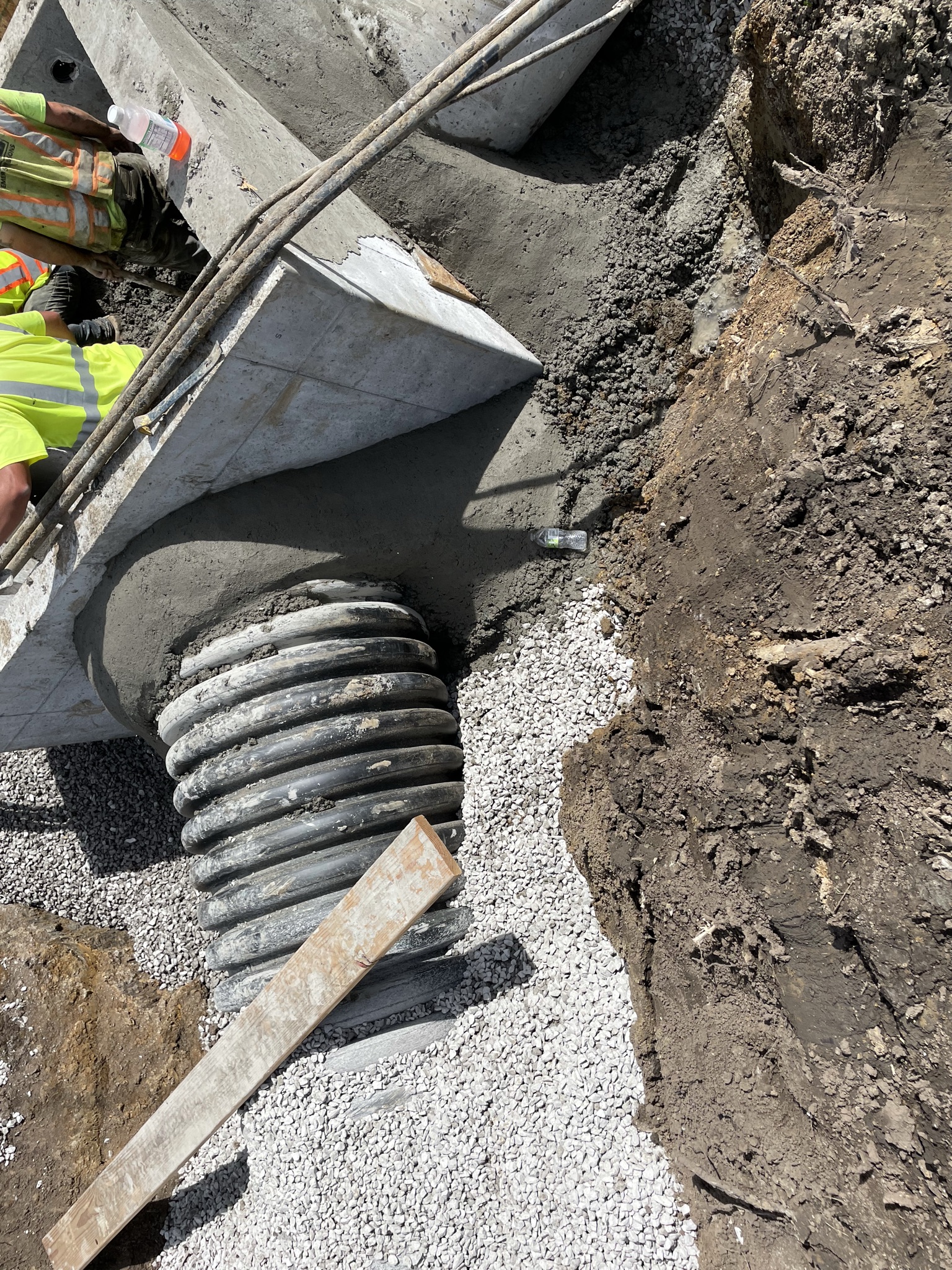

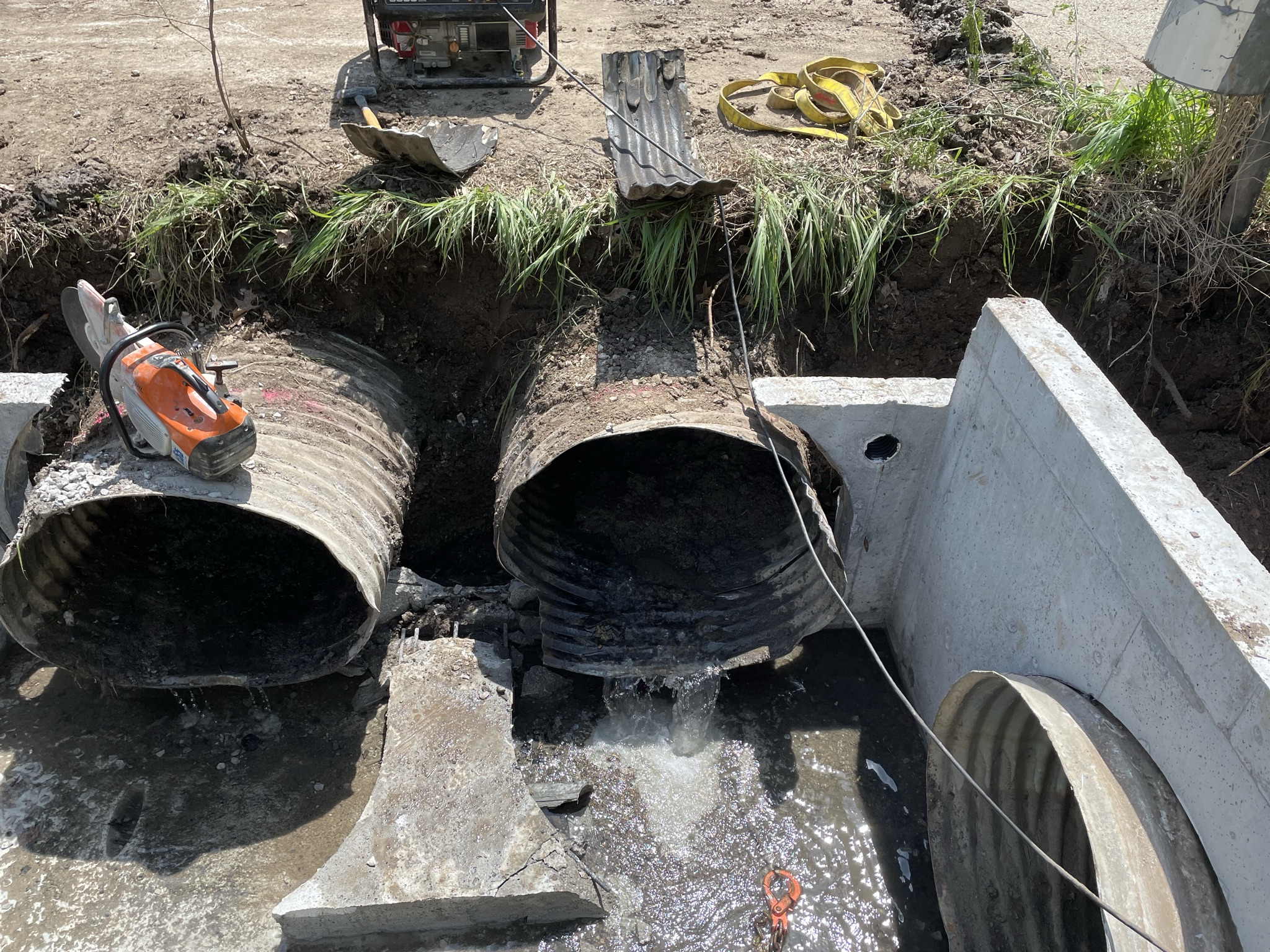

Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/06/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/06/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/06/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/06/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES
Site Visit Partial 06/08/2022
Misc
Informational
06/07/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/07/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/07/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/07/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/07/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/07/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/07/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES
Pavement-Aggregate Base Partial 06/08/2022
Misc
Informational
06/08/2022
Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES
Pavement-Curb Construction Partial 06/08/2022
Misc
Informational
06/03/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES
Site Visit Partial 06/14/2022
Misc
Informational
06/08/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/08/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/08/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/08/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/08/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/08/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/08/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on compacting curb line. 6/13/22 ES

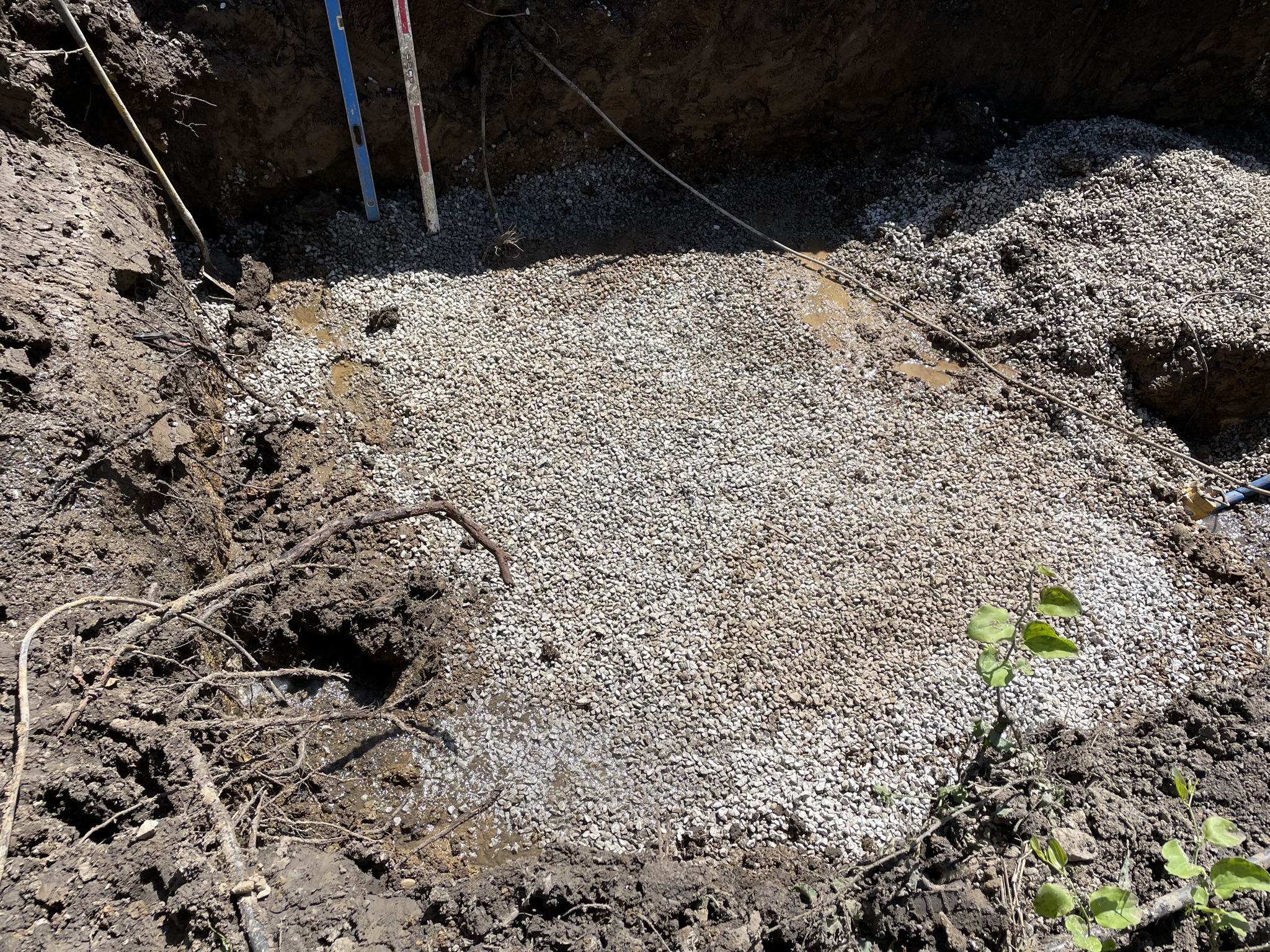

Pavement-Stabilized Subgrade Partial 06/14/2022
Misc
Informational
06/14/2022
ESS working on geogrid, rock and compacting curb line. 6/13/22 ES
Site Visit Partial 06/14/2022
Misc
Informational
06/14/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/14/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/14/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/14/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/14/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/14/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/14/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES
Pavement-Stabilized Subgrade Partial 06/14/2022
Misc
Informational
06/14/2022
ESS working on geogrid, rock and compacting curb line. 6/13/22 ES ESS working on geogrid, rock and compacting curb line around storm inlets at western edge of Black Twig Cir and Lowenstein Dr. 6/14/22 ES
Site Visit Partial 06/14/2022
Misc
Informational
06/14/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/14/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/14/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/14/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/14/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/14/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/14/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES
Pavement-Curb Construction Partial 06/14/2022
Misc
Informational
06/08/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES
Pavement-Stabilized Subgrade Partial 06/14/2022
Misc
Informational
06/14/2022
ESS working on geogrid and aggregate base for curb/roadway. 6/9/22 ES ESS working on geogrid, rock and compacting curb line. 6/13/22 ES ESS working on geogrid, rock and compacting curb line around storm inlets at western edge of Black Twig Cir and Lowenstein Dr. 6/14/22 ES
Pavement-Curb Construction Partial 06/14/2022
Misc
Informational
06/14/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES
Pavement-Stabilized Subgrade Partial 06/14/2022
Misc
Informational
06/14/2022
ESS working on geogrid and aggregate base for curb/roadway. 6/9/22 ES ESS working on geogrid and aggregate base for curb/roadway. 6/10/22 ES ESS working on geogrid, rock and compacting curb line. 6/13/22 ES ESS working on geogrid, rock and compacting curb line around storm inlets at western edge of Black Twig Cir and Lowenstein Dr. 6/14/22 ES
Pavement-Curb Construction Partial 06/14/2022
Misc
Informational
06/14/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES
Pavement-Curb Construction Partial 06/14/2022
Misc
Informational
06/14/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES
Pavement-Aggregate Base Partial 06/14/2022
Misc
Informational
06/14/2022
ESS crew had laid geogrid and aggregate base down curb line and edge of roadway. 6/14/22 ES
Site Visit Partial 06/20/2022
Misc
Informational
06/14/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/14/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/14/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/14/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/14/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/14/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/14/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES
Pavement-Curb Construction Partial 06/20/2022
Misc
Informational
06/14/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES
Site Visit Partial 06/20/2022
Misc
Informational
06/20/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/20/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/20/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/20/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/20/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/20/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES
Pavement-Aggregate Base Partial 06/20/2022
Misc
Informational
06/14/2022
ESS crew had laid geogrid and aggregate base down curb line and edge of roadway. 6/14/22 ES ESS finished up grading and grid 6/15/22 ES
Pavement-Curb Construction Partial 06/20/2022
Misc
Informational
06/20/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES
Site Visit Partial 06/20/2022
Misc
Informational
06/20/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/20/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/20/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/20/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/20/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/20/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES
Pavement-Proof Roll Passed 6/14/2022 6/14/2022 06/20/2022
Misc
Informational
06/20/2022
Not able to perform proof roll on this section with cutout from existing Lowenstein Dr. ESS worked base well and compacted. 6/15/22 ES
Pavement-Curb Construction Partial 07/11/2022
Misc
Informational
06/20/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES Crew working on curbs/inlets. 7/7/22 ES
Pavement-Curb Construction Partial 07/11/2022
Misc
Informational
07/11/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES Crew working on curbs/inlets. 7/7/22 ES Crew working on completing inlets on Lowenstein and framing up valley gutter and curbing for west side of BlackTwig Cir. 7/8/22 ES
Pavement-Curb Construction Partial 07/11/2022
Misc
Informational
07/11/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES Crew working on curbs/inlets. 7/7/22 ES Crew working on completing inlets on Lowenstein and framing up valley gutter and curbing for west side of BlackTwig Cir. 7/8/22 ES Lowenstein curb inlets and west side of BlackTwig Cir valley gutter and curbs framed up and ready to pour. 7/11/22 ES
Pavement-Surface Partial 07/11/2022
Misc
Informational
07/11/2022
Crews worked on backfilling between existing surface and curb, using KCMMB concrete to fill up to 2-3” below level. 7/7/22 ES
Site Visit Partial 07/11/2022
Misc
Informational
06/20/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
06/20/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
06/20/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
06/20/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
06/20/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
06/20/2022
No work being performed today. 4/28/22 ES
Misc
Informational
06/20/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES

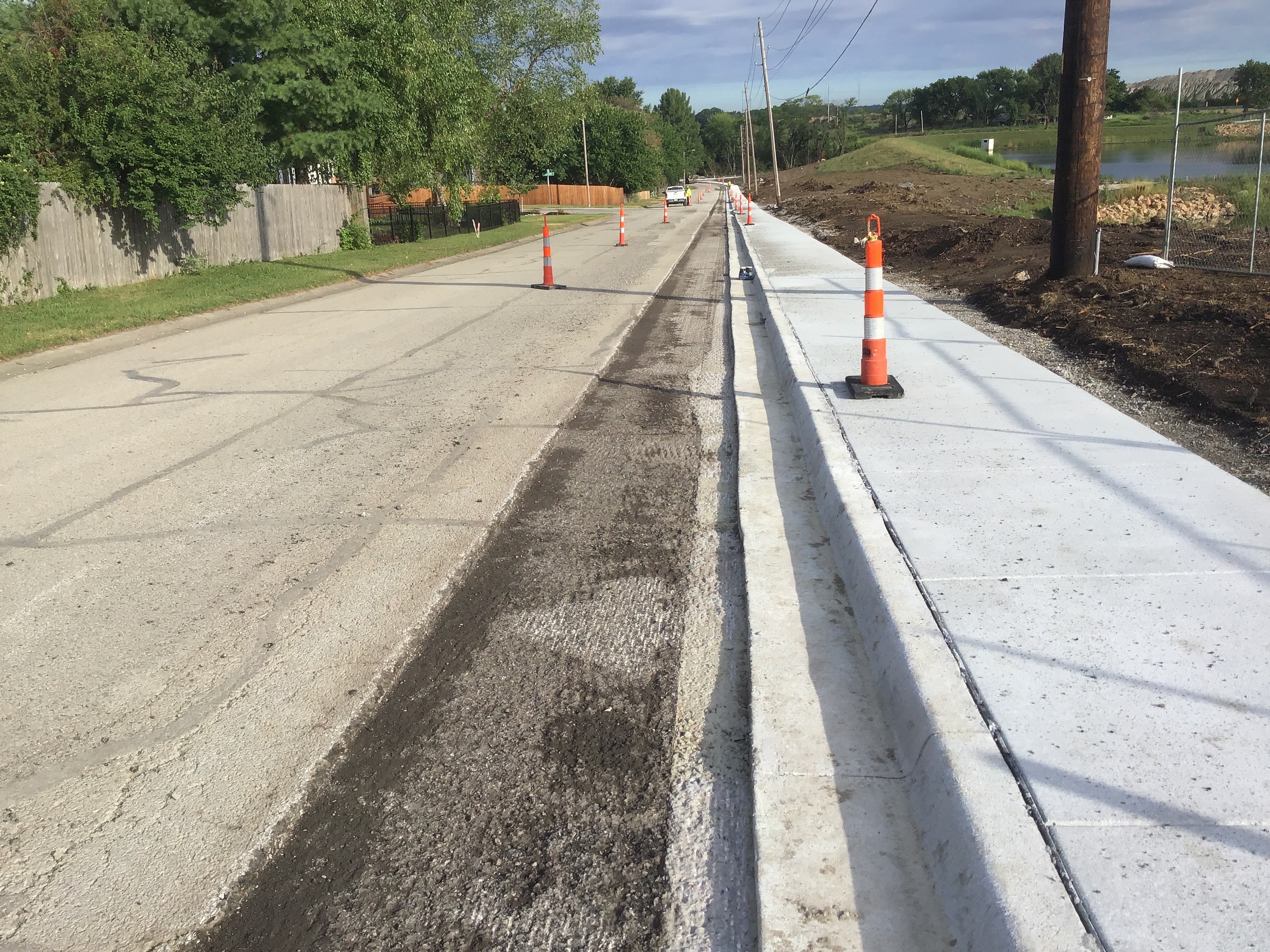

Pavement-Surface Partial 07/15/2022
Misc
Informational
07/11/2022
Crews worked on backfilling between existing surface and curb, using KCMMB concrete to fill up to 2-3” below level. 7/7/22 ES Marked out asphalt down Lowenstein and emailed Codi with what we want to see done with the wedging down this stretch. 7/15/22 ES 07/30/22 Saturday JMJ ( ESS Codi/ Seal-O-Matic ) Contractor has milled approximately 3’ to 4’ in length from the Northside side of curb on NW Lowenstein Drive ( starting from approximately 120’ West of NW Black Twig Ln to 850’ West of NW Autumn Ln). On NW Summerfield Dr & NW Autumn Ln 15’x15’ patch was milled around sewer lid. APWA Type 6 V asphalt was used for resurfacing. CFS showed up on site to take compaction test. First truck temperature averaged around 290 degrees. CFS inspector stated that the compaction test where in acceptable range.
Pavement-Aggregate Base Partial 07/15/2022
Misc
Informational
06/20/2022
ESS crew had laid geogrid and aggregate base down curb line and edge of roadway. 6/14/22 ES ESS finished up grading and grid 6/15/22 ES ESS finishing grading preparing for asphalt base. 7/15/22 ES
Site Visit Partial 07/19/2022
Misc
Informational
07/11/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
07/11/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/11/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
07/11/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
07/11/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
07/11/2022
No work being performed today. 4/28/22 ES
Misc
Informational
07/11/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES
Misc
Informational
07/19/2022
Backfilling curbs. 7/19/22 ES
Pavement-Curb Construction Partial 07/19/2022
Misc
Informational
07/11/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES Crew working on curbs/inlets. 7/7/22 ES Crew working on completing inlets on Lowenstein and framing up valley gutter and curbing for west side of BlackTwig Cir. 7/8/22 ES Lowenstein curb inlets and west side of BlackTwig Cir valley gutter and curbs framed up and ready to pour. 7/11/22 ES
Misc
Informational
07/19/2022
Backfilling curbs. 7/19/22 ES
Sidewalk Inspection Partial 07/22/2022
Misc
Informational
07/22/2022
JD Bishop concrete crew poured 62 yds of KCMMB 4K sidewalk along back edge of curb applying white cure as they went. 7/21/22 ES
Pavement-Curb Construction Passed 07/22/2022
Misc
Informational
07/19/2022
ESS crew working on base for curb line. 6/3/22 ES Spoke with Cody this morning, they plan on working on finishing up aggregate base and getting curbs in starting next week weather permitting. 6/8/22 ES ESS was working on geogrid and aggregate base. 6/9/22 ES ESS continued working on geogrid and aggregate base. 6/10/22 ES ESS working on geogrid and aggregate base near Lowenstein Dr and Black Twig Cir. 6/13/22 ES ESS was working on geogrid and aggregate base. 6/14/22 ES ESS working on curbs. 6/16/22 ES ESS doing cleanup on curbs. 6/17/22 ES Crew working on curbs/inlets. 7/7/22 ES Crew working on completing inlets on Lowenstein and framing up valley gutter and curbing for west side of BlackTwig Cir. 7/8/22 ES Lowenstein curb inlets and west side of BlackTwig Cir valley gutter and curbs framed up and ready to pour. 7/11/22 ES
Misc
Informational
07/19/2022
Backfilling curbs. 7/19/22 ES Curb construction completed including approach and entrance to cell tower road. 7/22/22 ES
Grading/Excavation/Fill Inspection Partial 07/26/2022
Misc
Informational
06/07/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES
Site Visit Partial 07/26/2022
Misc
Informational
07/19/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
07/19/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/19/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
07/19/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
07/19/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
07/19/2022
No work being performed today. 4/28/22 ES
Misc
Informational
07/19/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES
Misc
Informational
07/19/2022
Backfilling curbs. 7/19/22 ES No utility work being done. 7/25/22 ES
Erosion Control Inspection Partial 07/26/2022
Misc
Informational
03/24/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
03/24/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
07/26/2022
Rain day, no major erosion control issues. 7/25/22 ES
Pavement-Surface Partial 08/01/2022
Misc
Informational
07/15/2022
Crews worked on backfilling between existing surface and curb, using KCMMB concrete to fill up to 2-3” below level. 7/7/22 ES Marked out asphalt down Lowenstein and emailed Codi with what we want to see done with the wedging down this stretch. 7/15/22 ES Seal-O-Matic milled out 4’ from curb line and laid type 6 asphalt down north side of Lowenstein Dr. 7/30/22 ES
Grading/Excavation/Fill Inspection Partial 08/01/2022
Misc
Informational
07/26/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES ESS working on backfilling behind sidewalks. 8/1/22 ES
Erosion Control Inspection Partial 08/01/2022
Misc
Informational
07/26/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
07/26/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
07/26/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/01/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES
ESC - (Vegetation/Ground Cover) Partial 08/01/2022
Misc
Informational
08/01/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES
Sidewalk Inspection Partial 08/01/2022
Misc
Informational
07/22/2022
JD Bishop concrete crew poured 62 yds of KCMMB 4K sidewalk along back edge of curb applying white cure as they went. 7/21/22 ES JD Bishop crew poured ~8 yds of KCMMB sidewalk to finish up around approach and some on Black Twig Cir also. 7/29/22 ES
Grading/Excavation/Fill Inspection Partial 08/08/2022
Misc
Informational
08/01/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES ESS working on backfilling behind sidewalks. 8/1/22 ES ESS finished backfilling behind curbs and worked on getting straw wattles behind sidewalk. 8/8/22 ES
Erosion Control Inspection Partial 08/08/2022
Misc
Informational
08/01/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/01/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/01/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/01/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES
Erosion Control Inspection Partial 08/08/2022
Misc
Informational
08/08/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/08/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/08/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/08/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES
Storm Sewer Construction Inspection Partial 08/11/2022
Misc
Informational
05/23/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
05/23/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
05/23/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
05/23/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
05/23/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
05/23/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
05/23/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
05/23/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
05/23/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
05/23/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
05/23/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
05/23/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
05/23/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Misc
Informational
08/11/2022
ESS on site patching and storm boxes. 8/9/22 ES
Storm Sewer Construction Inspection Partial 08/11/2022
Misc
Informational
08/11/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
08/11/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
08/11/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
08/11/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
08/11/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
08/11/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
08/11/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
08/11/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
08/11/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
08/11/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
08/11/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
08/11/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Misc
Informational
08/11/2022
ESS on site patching and storm boxes. 8/9/22 ES ESS on site patching last few storm boxes and beginning to grout remainder. 8/10/22 ES
Storm Sewer Construction Inspection Partial 08/11/2022
Misc
Informational
08/11/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
08/11/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
08/11/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
08/11/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
08/11/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
08/11/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
08/11/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
08/11/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
08/11/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
08/11/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
08/11/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
08/11/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Misc
Informational
08/11/2022
ESS on site patching and storm boxes. 8/9/22 ES ESS on site patching last few storm boxes and beginning to grout remainder. 8/10/22 ES ESS doing finishing touches along Lowenstein Dr and on storm boxes. 8/11/22 ES
Erosion Control Inspection Partial 08/16/2022
Misc
Informational
08/08/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/08/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/08/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/08/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES
Site Visit Partial 08/16/2022
Misc
Informational
07/26/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
07/26/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
07/26/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
07/26/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
07/26/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
07/26/2022
No work being performed today. 4/28/22 ES
Misc
Informational
07/26/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES
Misc
Informational
07/26/2022
Backfilling curbs. 7/19/22 ES No utility work being done. 7/25/22 ES No utility work being done. 8/15/22 ES
Storm Sewer Construction Inspection Partial 08/16/2022
Misc
Informational
08/11/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
08/11/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
08/11/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
08/11/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
08/11/2022

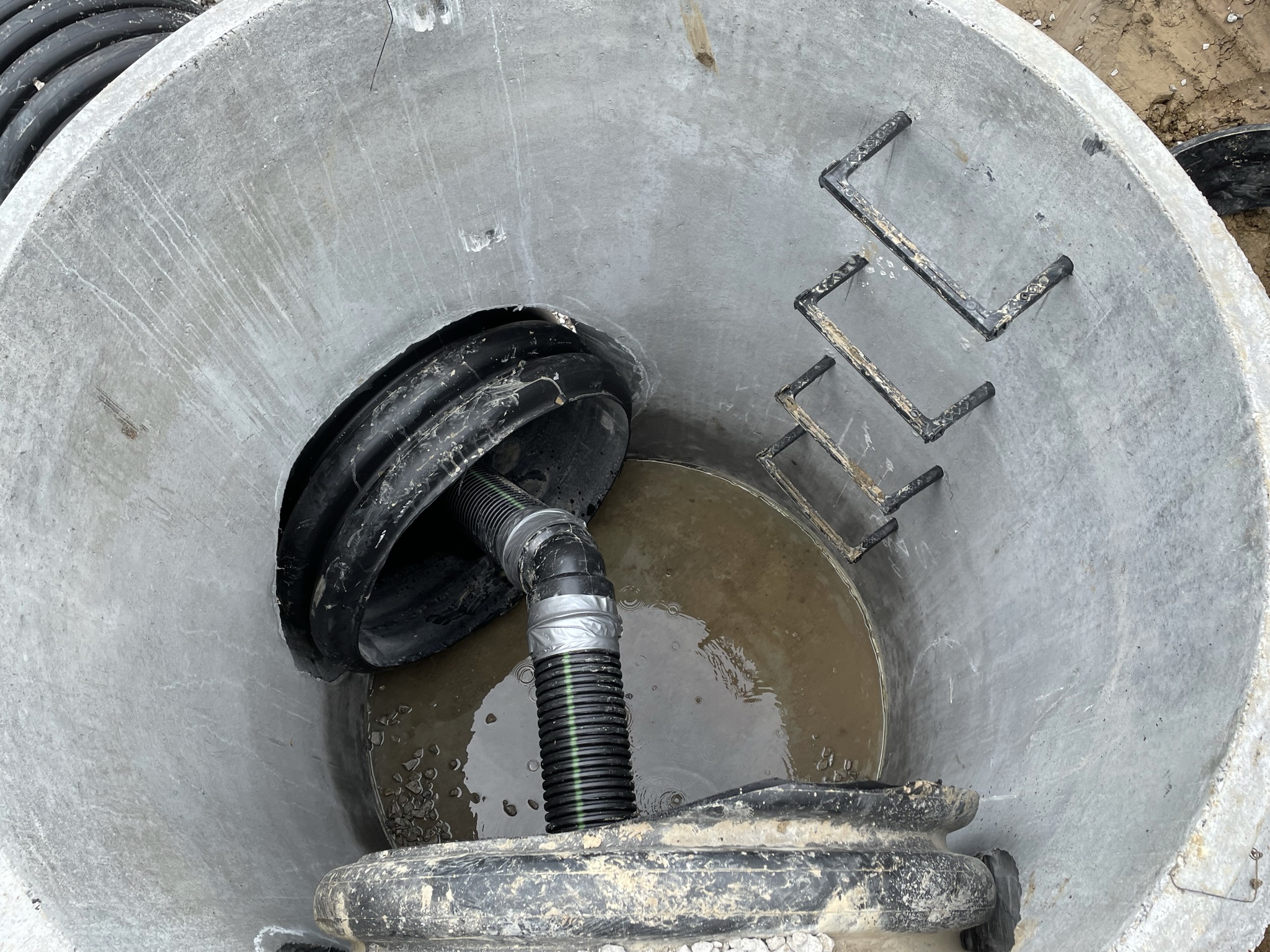

Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/11/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
08/11/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
08/11/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
08/11/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
08/11/2022

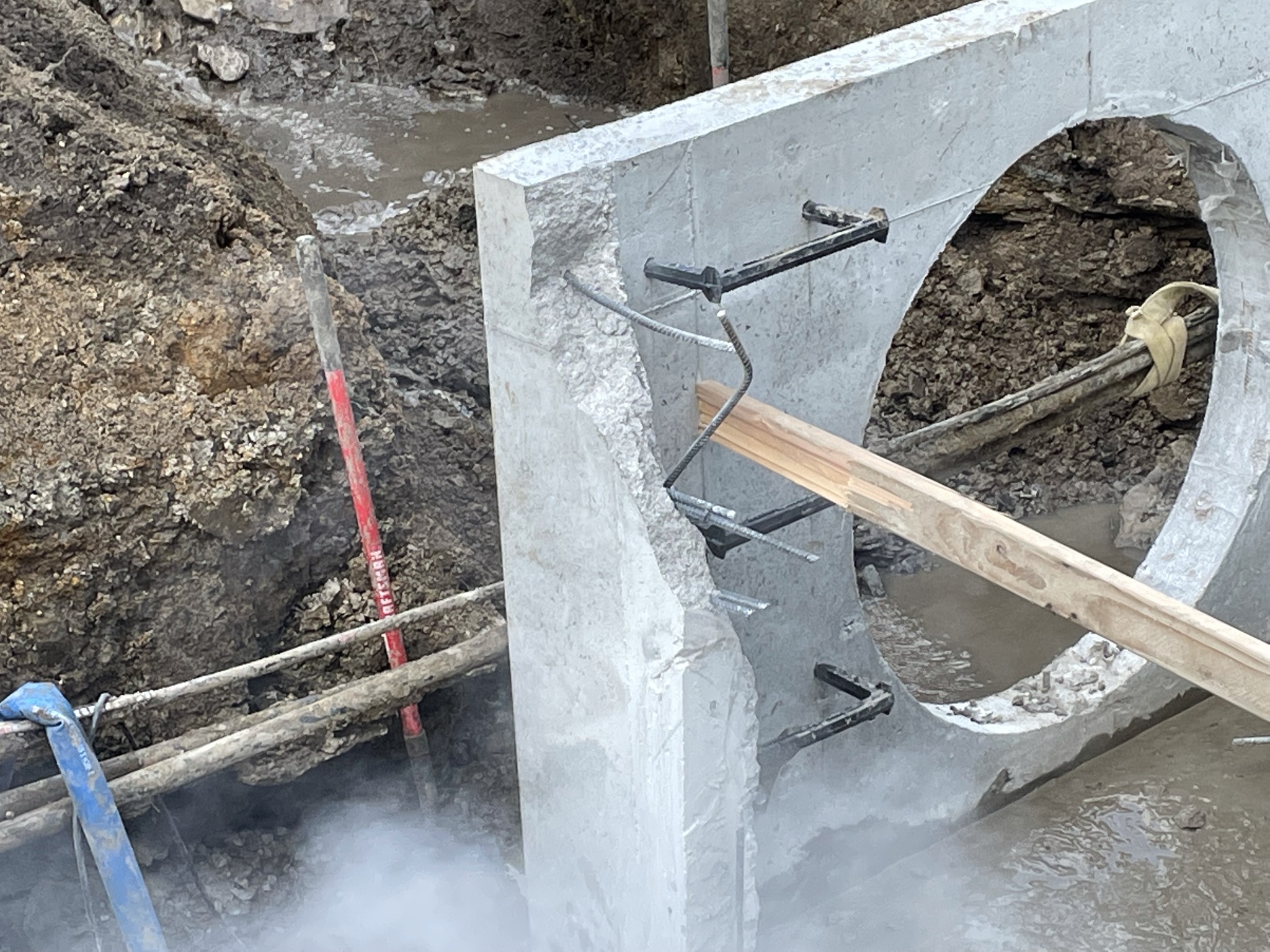

5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
08/11/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
08/11/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
08/11/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Misc
Informational
08/11/2022
ESS on site patching and storm boxes. 8/9/22 ES ESS on site patching last few storm boxes and beginning to grout remainder. 8/10/22 ES ESS doing finishing touches along Lowenstein Dr and on storm boxes. 8/11/22 ES 2 inlet boxes still need to have grout finished on front side of boxes. 8/15/22 ES
Site Visit Partial 08/16/2022
Misc
Informational
08/16/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
08/16/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/16/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
08/16/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
08/16/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/16/2022
No work being performed today. 4/28/22 ES
Misc
Informational
08/16/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES
Misc
Informational
08/16/2022
Backfilling curbs. 7/19/22 ES No utility work being done. 7/25/22 ES Performed walk through on infrastructure down Lowenstein Dr with Codi, Bob, and Steve. Noted a couple storm boxes that still need to be grouted, sidewalk, curbs and other inlet boxes appeared ok. 8/15/22 ES No utility work being done. 8/15/22 ES
ESC - (Vegetation/Ground Cover) Partial 08/17/2022
Misc
Informational
08/01/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES
Site Visit Partial 08/17/2022
Misc
Informational
08/16/2022
Too wet to work today with last nights rain, plus more rain coming to the area. No erosion issues to report. RP 3-22-22
Misc
Informational
08/16/2022
No utility work or grading being done today. RP 4-6-22
Misc
Informational
08/16/2022
Tyler’s crew started working on the storm line today. RP 4-19-22
Misc
Informational
08/16/2022
Tyler’s crew still working on storm line E. RP 4-20-22
Misc
Informational
08/16/2022
Tyler’s crew working on storm line. Still dealing with ATT cable running right down center of their ditch line. Had poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/16/2022
No work being performed today. 4/28/22 ES
Misc
Informational
08/16/2022
Tyler’s crew working on storm line.. 5/3/22 ES No utility work being done today. 5/31/22 ES ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS crew working along edge of roadway and working on grading at west entrance to Black Twig Cir. 6/7/22 ES No work being done today after last nights rain. 6/8/22 ES ESS working on curb line. 6/9/22 ES ESS continued working on curb line 6/10/22 ES ESS working on compacting curb line. 6/13/22 ES ESS working near West edge of Black Twig Cir on curb line. 6/14/22 ES ESS working on Curbs 6/16/22 ES ESS working on cleaning up from curbs. 6/17/22 ES No work being done on these sections today. 6/20/22 ES No crews onsite this morning. 7/11/22 ES
Misc
Informational
08/16/2022
Backfilling curbs. 7/19/22 ES No utility work being done. 7/25/22 ES Performed walk through on infrastructure down Lowenstein Dr with Codi, Bob, and Steve. Noted a couple storm boxes that still need to be grouted, sidewalk, curbs and other inlet boxes appeared ok. 8/15/22 ES No utility work being done. 8/15/22 ES No utility work being done. 8/16/22 ES

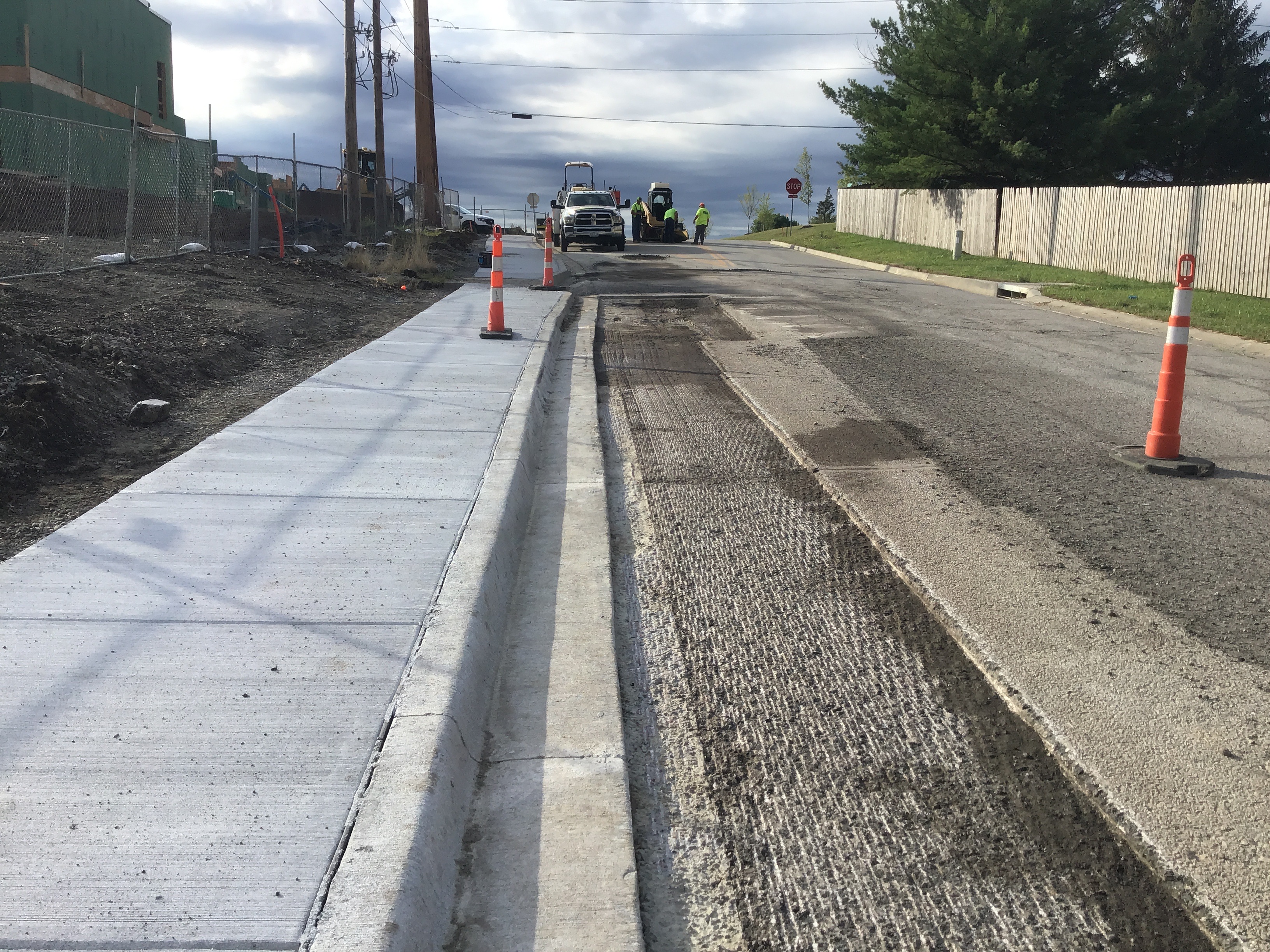

Pavement-Surface Passed 08/17/2022
Misc
Informational
08/01/2022
Crews worked on backfilling between existing surface and curb, using KCMMB concrete to fill up to 2-3” below level. 7/7/22 ES Marked out asphalt down Lowenstein and emailed Codi with what we want to see done with the wedging down this stretch. 7/15/22 ES Seal-O-Matic milled out 4’ from curb line and laid type 6 asphalt down north side of Lowenstein Dr. 7/30/22 ES
Pavement-Aggregate Base Passed 08/17/2022
Misc
Informational
07/15/2022
ESS crew had laid geogrid and aggregate base down curb line and edge of roadway. 6/14/22 ES ESS finished up grading and grid 6/15/22 ES ESS finishing grading preparing for asphalt base. 7/15/22 ES Asphalt laid down on 7/30/22 ES
Pavement-Stabilized Subgrade Passed 08/17/2022
Misc
Informational
06/14/2022
ESS working on geogrid and aggregate base for curb/roadway. 6/9/22 ES ESS working on geogrid and aggregate base for curb/roadway. 6/10/22 ES ESS working on geogrid, rock and compacting curb line. 6/13/22 ES ESS working on geogrid, rock and compacting curb line around storm inlets at western edge of Black Twig Cir and Lowenstein Dr. 6/14/22 ES Pavement laid 7/30/22 ES
Grading/Excavation/Fill Inspection Partial 08/17/2022
Misc
Informational
08/08/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES ESS working on backfilling behind sidewalks. 8/1/22 ES ESS finished backfilling behind curbs and worked on getting straw wattles behind sidewalk. 8/8/22 ES Landscaping crew working on laying straw mat along Lowenstein Dr. 8/15/22 ES
Sidewalk Inspection Passed 08/17/2022
Misc
Informational
08/01/2022
JD Bishop concrete crew poured 62 yds of KCMMB 4K sidewalk along back edge of curb applying white cure as they went. 7/21/22 ES JD Bishop crew poured ~8 yds of KCMMB sidewalk to finish up around approach and some on Black Twig Cir also. 7/29/22 ES Sidewalk completed along Lowenstein Dr. on 7/30/22 Meets LS and ADA spec. 8/15/22 ES
ESC - (Vegetation/Ground Cover) Partial 08/17/2022
Misc
Informational
08/17/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES
ESC - (Vegetation/Ground Cover) Partial 08/18/2022
Misc
Informational
08/17/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES
Storm Sewer Construction Inspection Passed 08/22/2022
Misc
Informational
08/16/2022
Tyler’s crew laid 100 feet of 18 inch RCP storm pipe for line E. RP 4-20-22
Misc
Informational
08/16/2022
Tyler’s crew ran into hard rock and had to run the breaker for every stick of pipe. They laid 64 feet of 18 inch RCP storm pipe. RP 4-21-22
Misc
Informational
08/16/2022
Tyler’s crew laid 50 feet of 18 inch RCP, still having to break rock along the line. RP 4-22-22
Misc
Informational
08/16/2022
Tyler’s crew was running into rock and utilities within their pipe area. Laid 32’ of RCP. 4/25/22 ES
Misc
Informational
08/16/2022

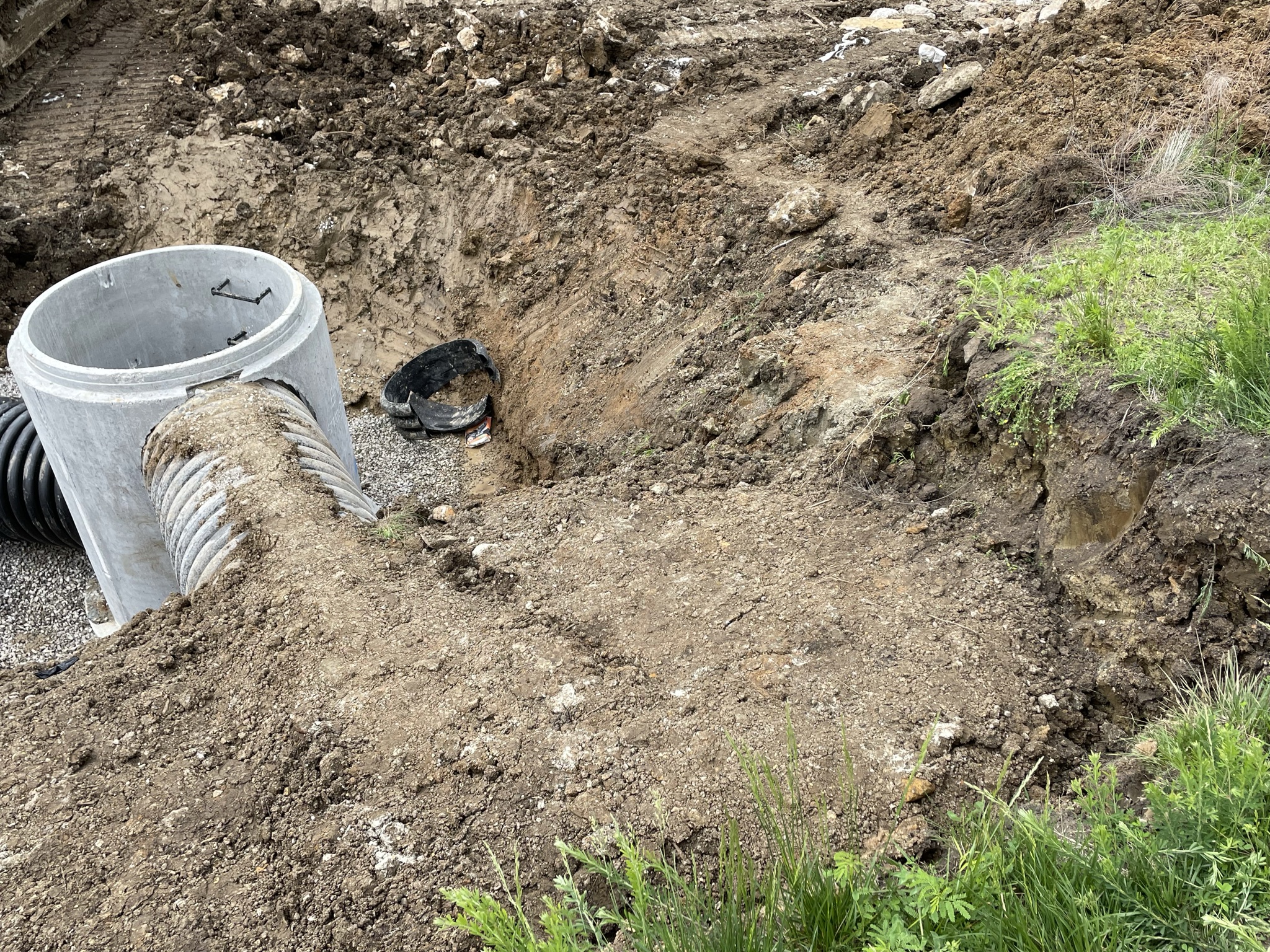

Tyler’s crew laid 48’ of RCP pipe for storm line E and set inlet E-5. 4/26/22 ES
Misc
Informational
08/16/2022
Tyler’s crew poured collars and inverts in storm box E-5 and had 3 sticks of pipe in early in day. 4/27/22 ES
Misc
Informational
08/16/2022
Tyler’s crew laid 16’ of RCP storm pipe before being rained out. 4/28/22 ES
Misc
Informational
08/16/2022
Tyler’s crew was starting on installing RCP pipe before being rained out. 4/29/22 ES
Misc
Informational
08/16/2022
Tyler’s crew installed 10 sticks of RCP prior to being rained out for the day. 5/2/22 ES
Misc
Informational
08/16/2022
Tyler’s crew finished the east portion of storm line E. Terminating at box E-6. Will be pouring collars and inverts in the morning. 5/3/22 ES Top step of box E-6 is bent and will need to be replaced. 5/3/22 ES Tyler’s crew busted out existing storm box and placed storm junction box E-1. Reseated existing 48”x34” CMP outflow pipe. Was preparing to lay inflow pipes to pour collars and inverts first thing in morning. 5/11/22 ES
Misc
Corrective Action Required
08/16/2022
5-12-22 AN crew was pouring collars and inverts on the storm box E-1 at the end of road on lownenstein dr. Existing storm pipe under the road needs to be cleaned out pic attached
Misc
Informational
08/16/2022
5-12-22 AN on the existing storm pipe under the road . I asked the super if he would clean out the dirt about 2ft in and he agreed 5-12-22 invert is complete on the storm box E-1 at the bottom of the hill
Misc
Informational
08/16/2022
Tylers crew continued laying 2 - 34”x22” RCP pipe making it to storm box E-2 and 1 stick of 42”x27” RCP out of storm box E-2. 5/16/22 ES
Misc
Informational
08/16/2022
Tyler’s crew continued on storm line E, putting 9 total sticks of 42”x27” RCP pipe in from box E-2. Also poured collars and inverts for box E-2. Had a minor repair on the bell of stick #8 out from box E-2 used manufacturer approved(Speed Crete Red Line) delivered by manufacturer to repair bell portion. 5/17/22 ES Tyler’s crew working on getting box E-3 set in. 5/18/22 ES Tyler’s crew got box E-3 in, had to reform up the west wall of the box. 5/18/22 ES Tyler’s crew got box E-3 west wall reformed and poured this morning. They started working 18” pipe out towards the East towards box E-4. 5/19/22 ES Rudy’s crew laid 52’ of 36” HDPE pipe storm line F from Box E-3 going towards overflow from pond. 5/19/22 ES Tyler’s crew completed line E but completing 18” RCP pipe from E-3 to E-4. Poured collars and inverts on boxes E-3. 5/19/22 ES Tyler’s crew poured collars and invert in box E-4. Also completed line F and set junction box and poured collars and invert. 5/20/22 ES
Misc
Informational
08/16/2022
ESS on site patching and storm boxes. 8/9/22 ES ESS on site patching last few storm boxes and beginning to grout remainder. 8/10/22 ES ESS doing finishing touches along Lowenstein Dr and on storm boxes. 8/11/22 ES 2 inlet boxes still need to have grout finished on front side of boxes. 8/15/22 ES Codi had crews patch 2 storm boxes that still needed grout. 8/18/22 ES
Erosion Control Inspection Partial 08/22/2022
Misc
Informational
08/16/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/16/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/16/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/16/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES
ESC - (Vegetation/Ground Cover) Partial 08/23/2022
Misc
Informational
08/18/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES
Grading/Excavation/Fill Inspection Partial 08/23/2022
Misc
Informational
08/17/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES ESS working on backfilling behind sidewalks. 8/1/22 ES ESS finished backfilling behind curbs and worked on getting straw wattles behind sidewalk. 8/8/22 ES Landscaping crew working on laying straw mat along Lowenstein Dr. 8/15/22 ES Landscaping crew completed laying straw mat and seeding along Lowenstein Dr and up Black Twig Cir. 8/19/22 ES
Grading/Excavation/Fill Inspection Passed 08/23/2022
Misc
Informational
08/23/2022
ESS has a crew working on filling in back of pond damn near BlackTwig/Lowenstein Dr. Also working on moving fill from along side of Lowenstein Dr from storm sewer construction. 6/6/22 ES ESS had crew onsite working on cleaning down roadways. Also started grading at west entrance of Black Twig Cir. 6/7/22 ES ESS crew working on clearing sidewalk areas. While JD Bishop crew worked on sidewalks. 7/22/22 ES ESS working on backfilling behind sidewalks. 8/1/22 ES ESS finished backfilling behind curbs and worked on getting straw wattles behind sidewalk. 8/8/22 ES Landscaping crew working on laying straw mat along Lowenstein Dr. 8/15/22 ES Landscaping crew completed laying straw mat and seeding along Lowenstein Dr and up Black Twig Cir. 8/19/22 ES Grading completed and vegetation has began growing along Lowenstein Dr where seed and straw mat was placed. 8/23/22 ES
Erosion Control Inspection Partial 09/09/2022
Misc
Informational
08/22/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
08/22/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
08/22/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
08/22/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES
ESC - (Vegetation/Ground Cover) Partial 09/09/2022
Misc
Informational
08/23/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES
ESC - (Vegetation/Ground Cover) Partial 09/16/2022
Misc
Informational
09/09/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES
Erosion Control Inspection Partial 09/16/2022
Misc
Informational
09/09/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
09/09/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
09/09/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
09/09/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES
Install Street and Stop Signs Partial 09/16/2022
Misc
Informational
09/16/2022
ESS will have contractor putting signs up along Lowenstien Dr and Black Twig Cir in next couple of weeks. 9/16/22
Erosion Control Inspection Partial 09/27/2022
Misc
Informational
09/16/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
09/16/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
09/16/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
09/16/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES Only wattles remain along Lowenstein and western Black Twig cir. Vegetation is well established. 9/26/22 ES
Install Street and Stop Signs Partial 09/27/2022
Misc
Informational
09/27/2022
Spoke with Codi, ESS has a contractor who will be putting up the signs along Black Twig Cir and Lowenstein Dr. 9/26/22 ES
ESC - (Vegetation/Ground Cover) Partial 09/27/2022
Misc
Informational
09/16/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES
Erosion Control Inspection Partial 10/03/2022
Misc
Informational
09/27/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
09/27/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
09/27/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
09/27/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES Only wattles remain along Lowenstein and western Black Twig cir. Vegetation is well established. 9/26/22 ES Wattles remain in place along Lowenstein Dr and western Black Twig cir. No erosion issues noted. 10/3/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/03/2022
Misc
Informational
09/27/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES
Erosion Control Inspection Partial 10/11/2022
Misc
Informational
10/03/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/03/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/03/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
10/03/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES Only wattles remain along Lowenstein and western Black Twig cir. Vegetation is well established. 9/26/22 ES Wattles remain in place along Lowenstein Dr and western Black Twig cir. No erosion issues noted. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/14/2022
Misc
Informational
10/03/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES Next to Nature onsite planting trees along west side of Black Twig Cir. 10/14/22 ES
Erosion Control Inspection Partial 10/19/2022
Misc
Informational
10/11/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/11/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/11/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
10/11/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES Only wattles remain along Lowenstein and western Black Twig cir. Vegetation is well established. 9/26/22 ES Wattles remain in place along Lowenstein Dr and western Black Twig cir. No erosion issues noted. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/19/2022
Misc
Informational
10/14/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES Next to Nature onsite planting trees along west side of Black Twig Cir. 10/14/22 ES Next to Nature still working on getting trees planted. 10/18/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/20/2022
Misc
Informational
10/19/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES Next to Nature onsite planting trees along west side of Black Twig Cir. 10/14/22 ES Next to Nature still working on getting trees planted. 10/18/22 ES Next to Nature planting trees and vegetation. 10/19/22 ES
Install Street and Stop Signs Partial 10/12/2022 10/12/2022 10/21/2022
Misc
Informational
09/27/2022
Spoke with Codi, ESS has a contractor who will be putting up the signs along Black Twig Cir and Lowenstein Dr. 9/26/22 ES "NO OUTLET" sign installed on western edge of Lowenstein at Black Twig Cir. Still no "STOP" sign on west outlet of Black Twig Cir. 10/21/22 ES
ESC - (Vegetation/Ground Cover) Partial 10/21/2022
Misc
Informational
10/20/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES Next to Nature onsite planting trees along west side of Black Twig Cir. 10/14/22 ES Next to Nature still working on getting trees planted. 10/18/22 ES Next to Nature planting trees and vegetation. 10/19/22 ES Next to Nature watering trees. 10/21/22 ES
ESC - (Vegetation/Ground Cover) Partial 11/08/2022
Misc
Informational
10/21/2022
Codi was going to speak with Dave about what vegetation they would be putting behind sidewalk and going down along sides of retention basins. 8/1/22 ES Crew was out laying out straw mat along Lowenstein Dr. 8/15/22 ES Next to Nature onsite seeding and laying straw mat down along Lowenstein Dr. 8/17/22 ES Next to Nature Finished putting straw mat down Lowenstein Dr. 8/18/22 ES Areas where Next to Nature put seed and straw is beginning to vegetate and grow grass. 8/22/22 ES Large portions of areas along western Black Twig Cir and Lowenstein Dr have established vegetation. Left straw wattles in place, but removed gutter buddies from Lowenstein Dr. Left gutter buddies with cinder blocks behind them along Black Twig Cir. 9/9/22 ES Majority of area is vegetated, leaving straw wattles in place currently, but removed gutter buddies along Lowenstein Dr. 9/16/22 ES Vegetation is established around western Black Twig Cir and down Lowenstein Dr. Wattles remain in place currently. 9/26/22 ES Vegetation established, new areas where utilities have done work are seeded with straw in place. 10/3/22 ES Next to Nature onsite planting trees along west side of Black Twig Cir. 10/14/22 ES Next to Nature still working on getting trees planted. 10/18/22 ES Next to Nature planting trees and vegetation. 10/19/22 ES Next to Nature watering trees. 10/21/22 ES Next to Nature planting trees. 11/7/22 ES
Erosion Control Inspection Partial 11/08/2022
Misc
Informational
10/19/2022
No erosion issues to report on the job site today. RP 3-23-22
Misc
Informational
10/19/2022
Another rain day, still no erosion issues to report. RP 3-24-22
Misc
Informational
10/19/2022
Rain day, no major erosion control issues. 7/25/22 ES
Misc
Informational
10/19/2022
No erosion issues currently, but missing erosion control measures due to sidewalk being installed and backfilled. 8/1/22 ES ESS installed straw wattles behind sidewalk after backfilling. 8/8/22 ES Also spoke with Codi about putting blocks behind gutter buddies at inlet boxes. 8/8/22 ES Erosion control measures installed and functioning. Spoke with Codi again about blocks behind gutter buddies at inlet boxes. 8/15/22 ES Erosion control measures installed, intact, and functioning. Still need blocks behind gutter buddies at inlet boxes on Black Twig Cir and Lowenstein Dr. 8/22/22 ES Codi removed gutter buddies from Lowenstein Dr, with exception to the furthest west large inlet. At this location and along the western edge of Black Twig DR he put cinder blocks behind gutter buddies. 9/9/22 ES Vegetation is well established along Lowenstein Dr. leaving straw wattles in place, but gutter buddies have been removed. 9/16/22 ES Only wattles remain along Lowenstein and western Black Twig cir. Vegetation is well established. 9/26/22 ES Wattles remain in place along Lowenstein Dr and western Black Twig cir. No erosion issues noted. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Erosion control measures installed, intact, and functioning. 11/7/22 ES
Documents & Images
Date Uploaded File Type Document Name

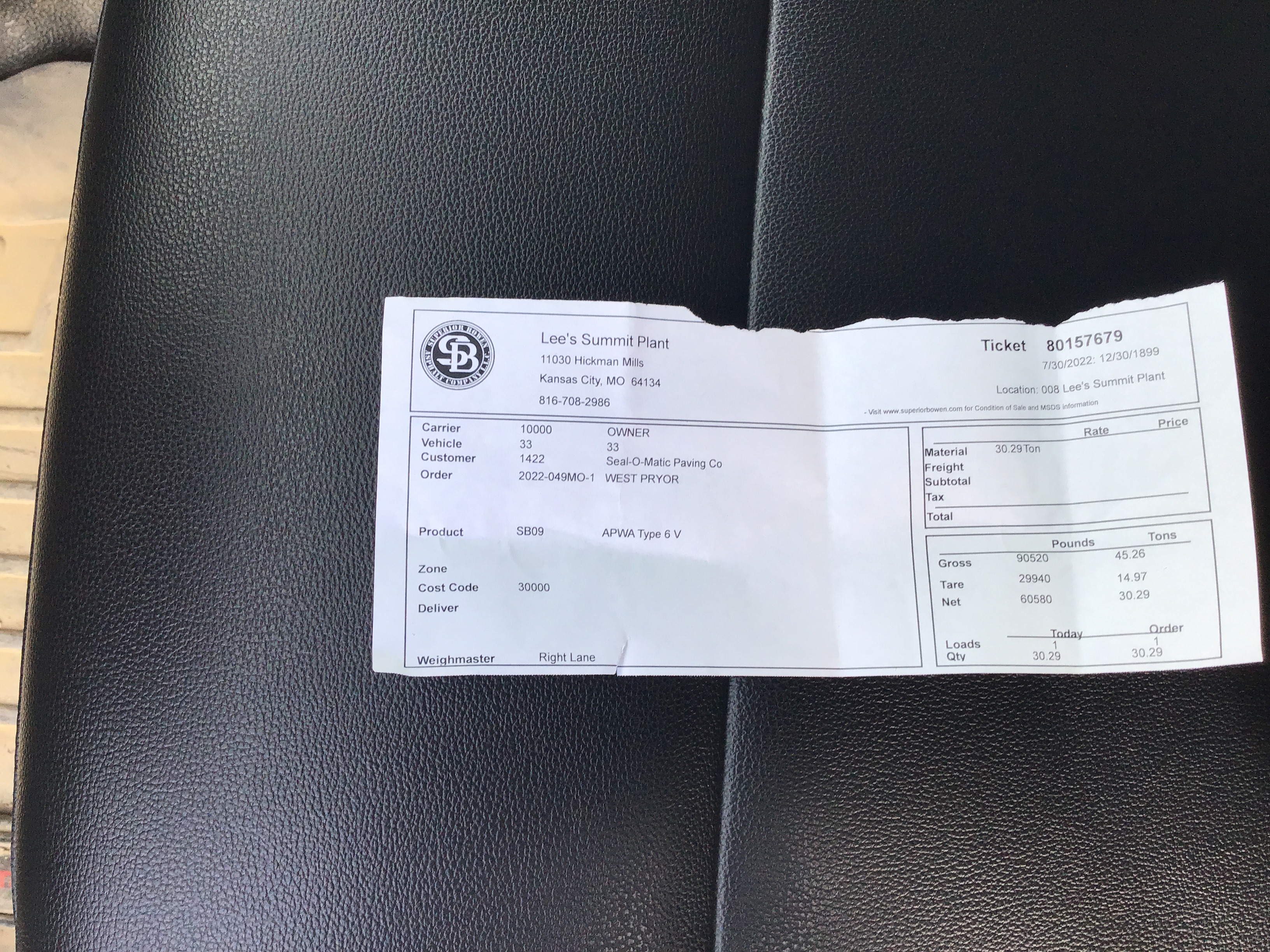

02/15/2022 Receipt Receipt for transaction:2022-000825
02/24/2022 Approved Plans SOWP Phase II Lowenstein Dr Approved 2.24.22
03/08/2022 Letter DE-Permit
03/22/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
03/24/2022 Letter INSPECTION SUMMARY
04/06/2022 Letter INSPECTION SUMMARY
04/19/2022 Letter INSPECTION SUMMARY
04/19/2022 Letter INSPECTION SUMMARY

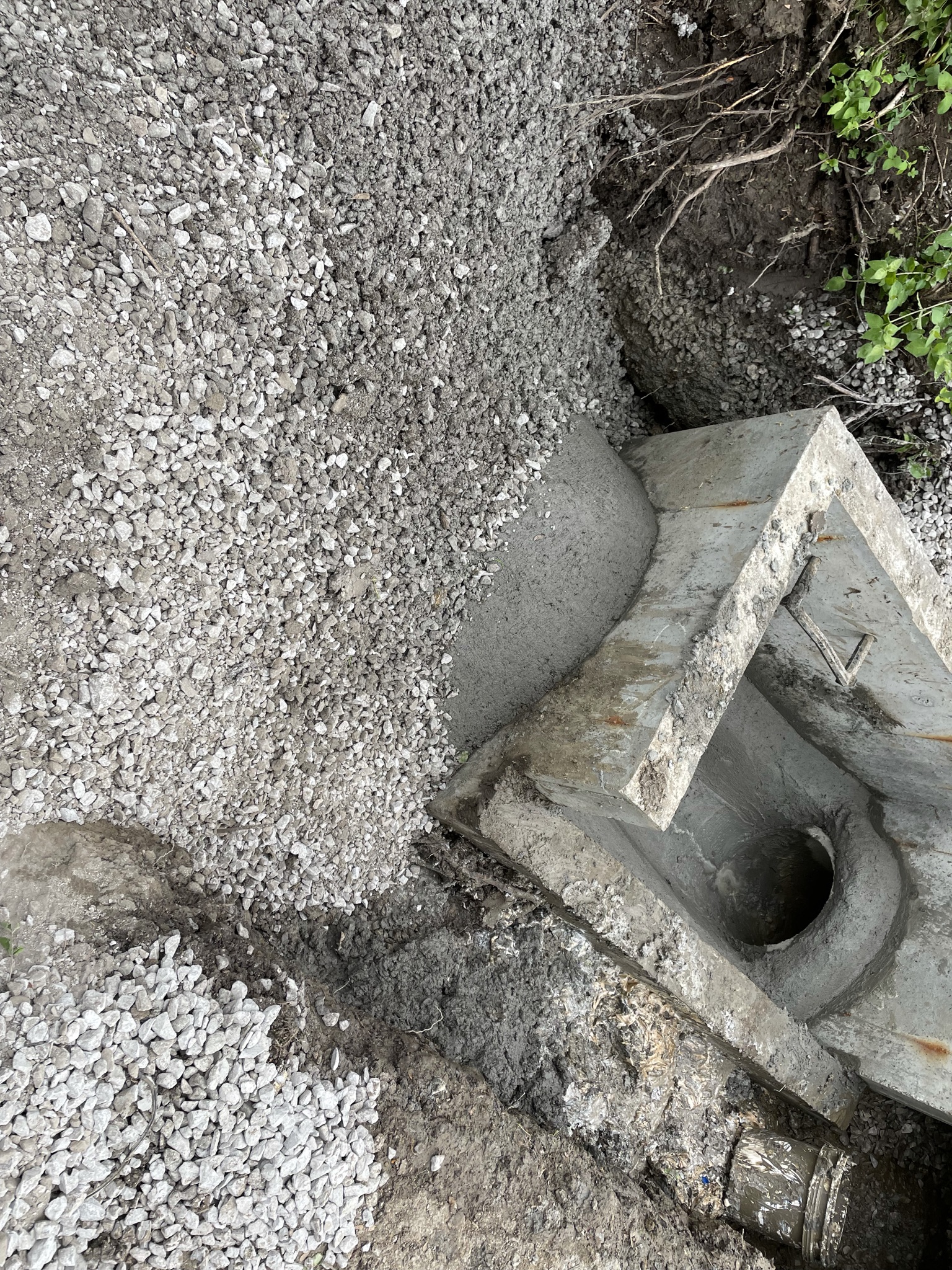

04/19/2022 Curb Inlet E-4
04/20/2022 Letter INSPECTION SUMMARY
04/20/2022 Letter INSPECTION SUMMARY
04/21/2022 Letter INSPECTION SUMMARY
04/22/2022 Letter INSPECTION SUMMARY
04/25/2022 Letter INSPECTION SUMMARY
04/26/2022 Letter INSPECTION SUMMARY

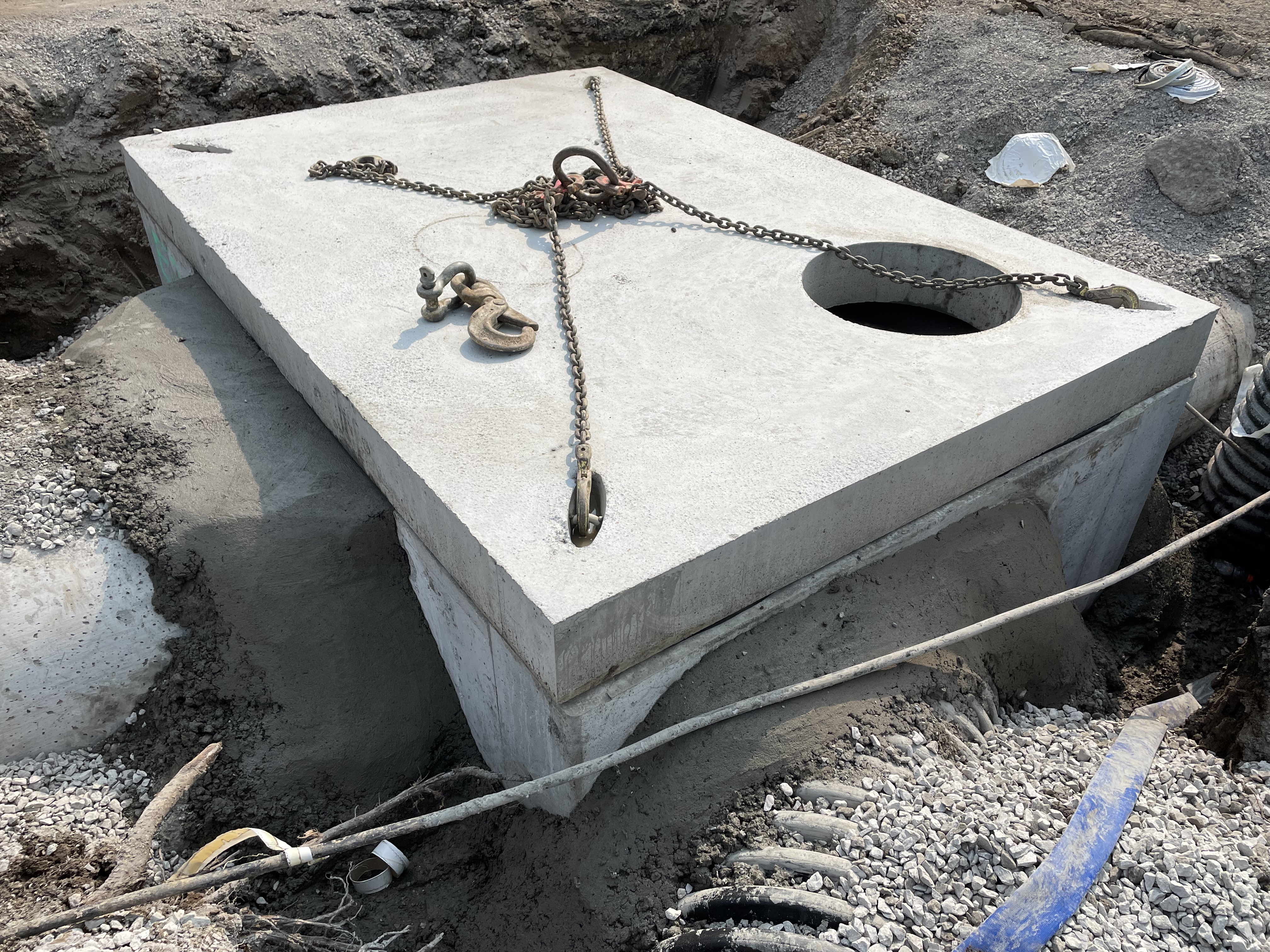

04/27/2022 Curb Inlet E-5
04/27/2022 Letter INSPECTION SUMMARY
04/27/2022 Letter INSPECTION SUMMARY
04/28/2022 Letter INSPECTION SUMMARY
04/29/2022 Letter INSPECTION SUMMARY
04/29/2022 Letter INSPECTION SUMMARY
05/03/2022 Letter INSPECTION SUMMARY
05/03/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 2844B0D0-EB8C-4D2A-828E-4DAD9BFA52C6
05/12/2022 F15DCA5C-AC85-4329-8D75-12D982DA91AB
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY

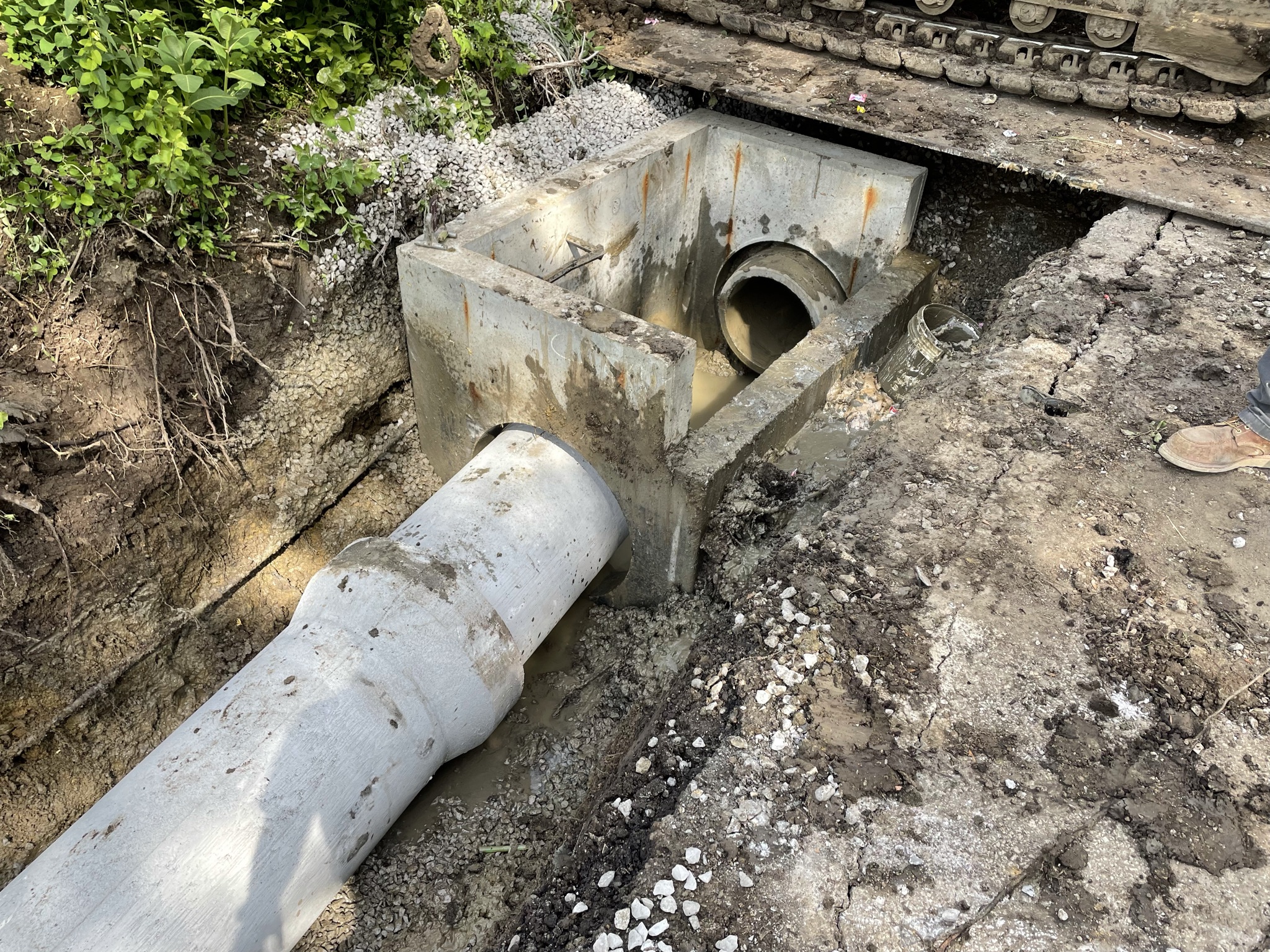

05/12/2022 Pipe 1 coming under Lowenstein Dr to inlet E-1
05/12/2022 Pipe 2 coming under Lowenstein Dr to inlet E-1
05/17/2022 Letter INSPECTION SUMMARY
05/17/2022 Letter INSPECTION SUMMARY

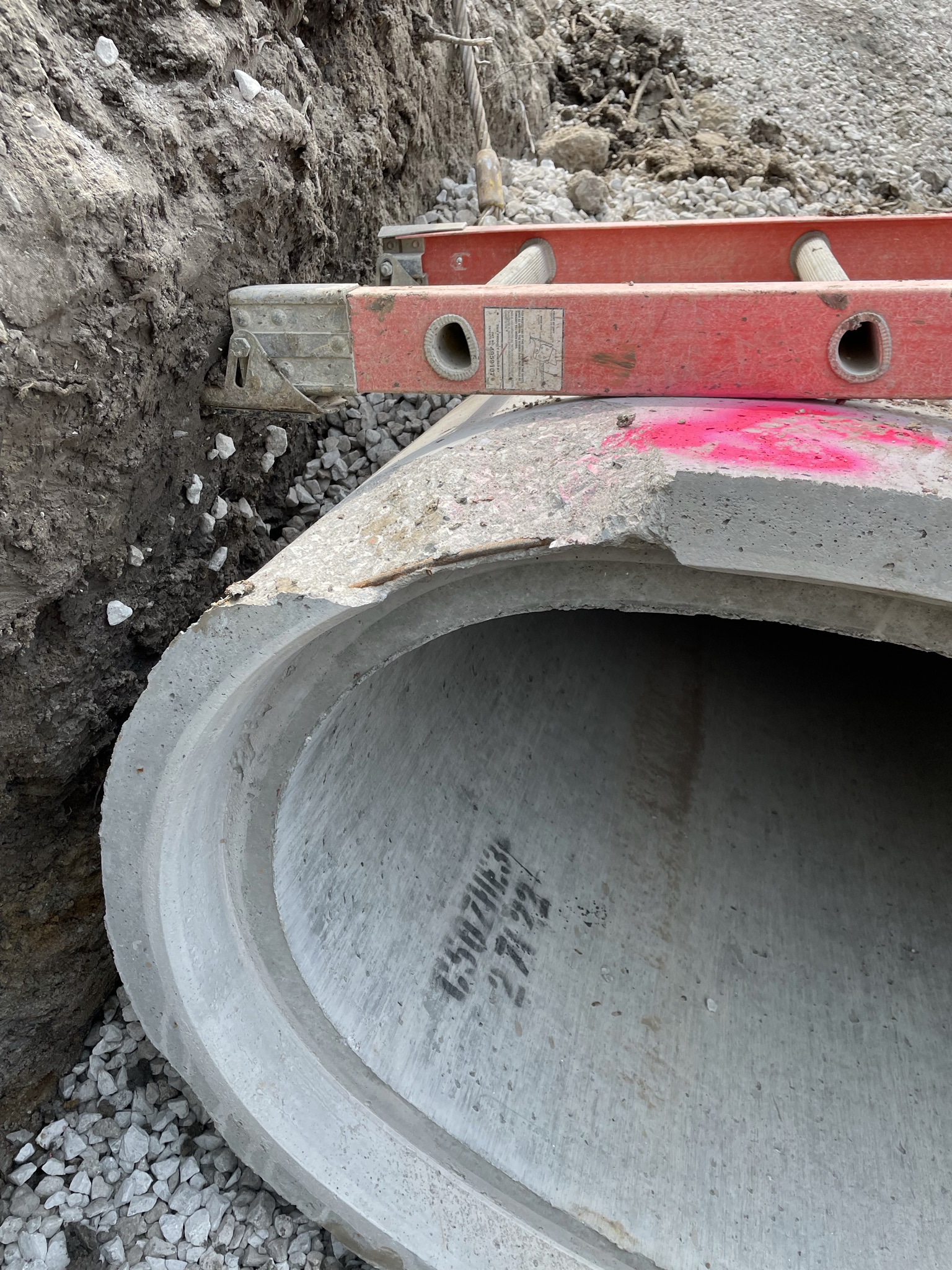

05/18/2022 Manufacturers approved RCP patch
05/18/2022 Manufacturers approved RCP patch 2
05/18/2022 Patch on pipe 8 out of E-2

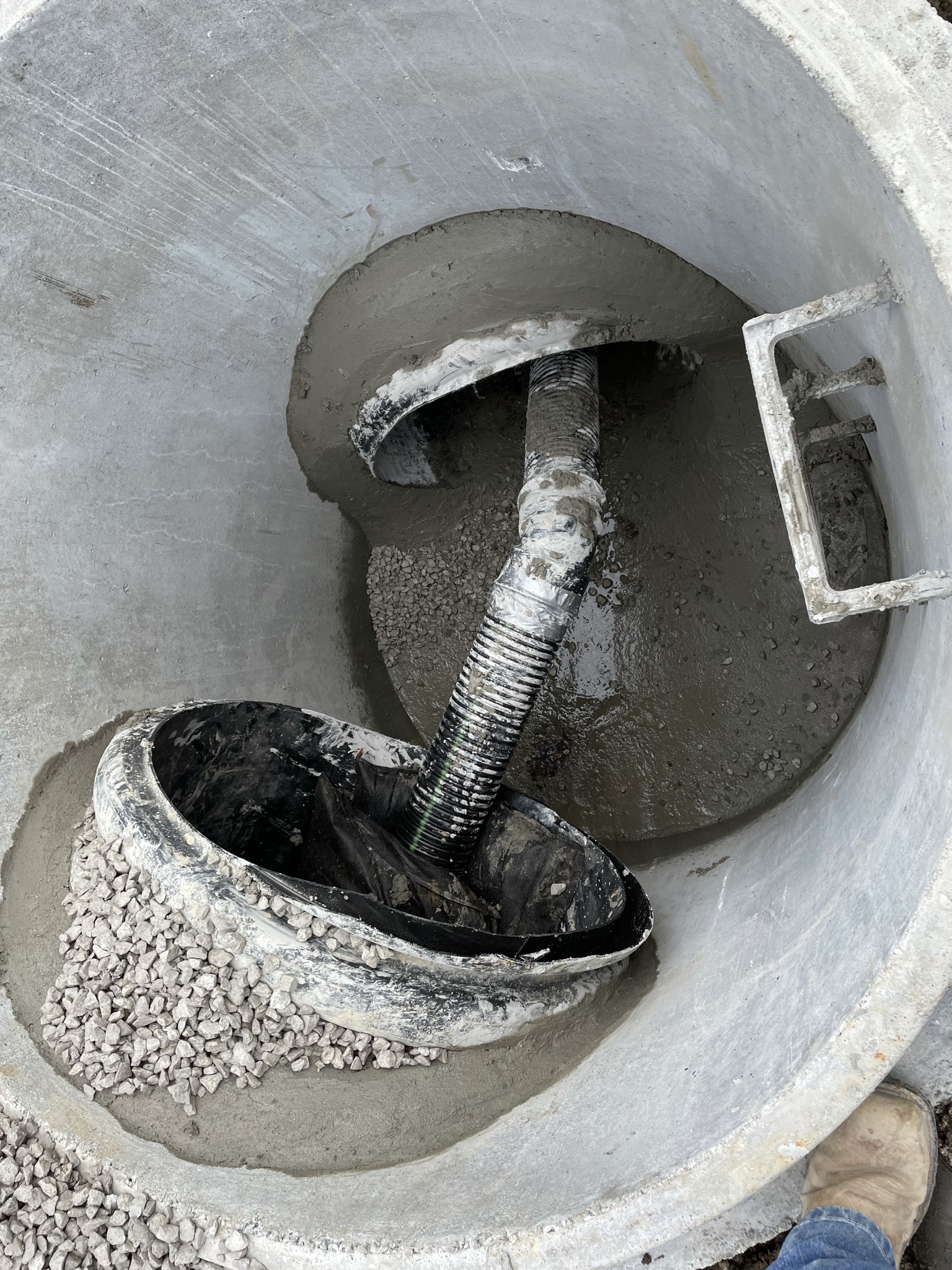

05/18/2022 Storm box E-2 lid set
05/18/2022 Storm box E-2 invert
05/18/2022 Storm box E-2 inverts from south
05/18/2022 Storm box E-2 west side collars
05/18/2022 Storm box E-2 before inverts or collars
05/18/2022 Letter INSPECTION SUMMARY
05/19/2022 Letter INSPECTION SUMMARY
05/19/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/23/2022 Letter INSPECTION SUMMARY
05/31/2022 Letter INSPECTION SUMMARY
05/31/2022 Letter INSPECTION SUMMARY
05/31/2022 Letter INSPECTION SUMMARY
06/03/2022 Letter INSPECTION SUMMARY
06/06/2022 Letter INSPECTION SUMMARY
06/06/2022 Letter INSPECTION SUMMARY
06/06/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/08/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/14/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
06/20/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/15/2022 Letter INSPECTION SUMMARY
07/15/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/22/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
07/30/2022 image
07/30/2022 image0
07/30/2022 image1
07/30/2022 image2
07/30/2022 image3
07/30/2022 image4
07/30/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY
08/16/2022 Letter INSPECTION SUMMARY
08/16/2022 Letter INSPECTION SUMMARY
08/16/2022 Letter INSPECTION SUMMARY
08/16/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY
08/18/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
09/02/2022 Streets of West Pryor Phase II Lowenstein Road Improvements Substantial Completion
09/09/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter DE-Punch List
09/09/2022 Letter DE-Certificate of Substantial Completion Single Lot
09/09/2022 Letter INSPECTION SUMMARY
09/16/2022 Letter INSPECTION SUMMARY
09/16/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/14/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
10/21/2022 Letter INSPECTION SUMMARY
10/21/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY

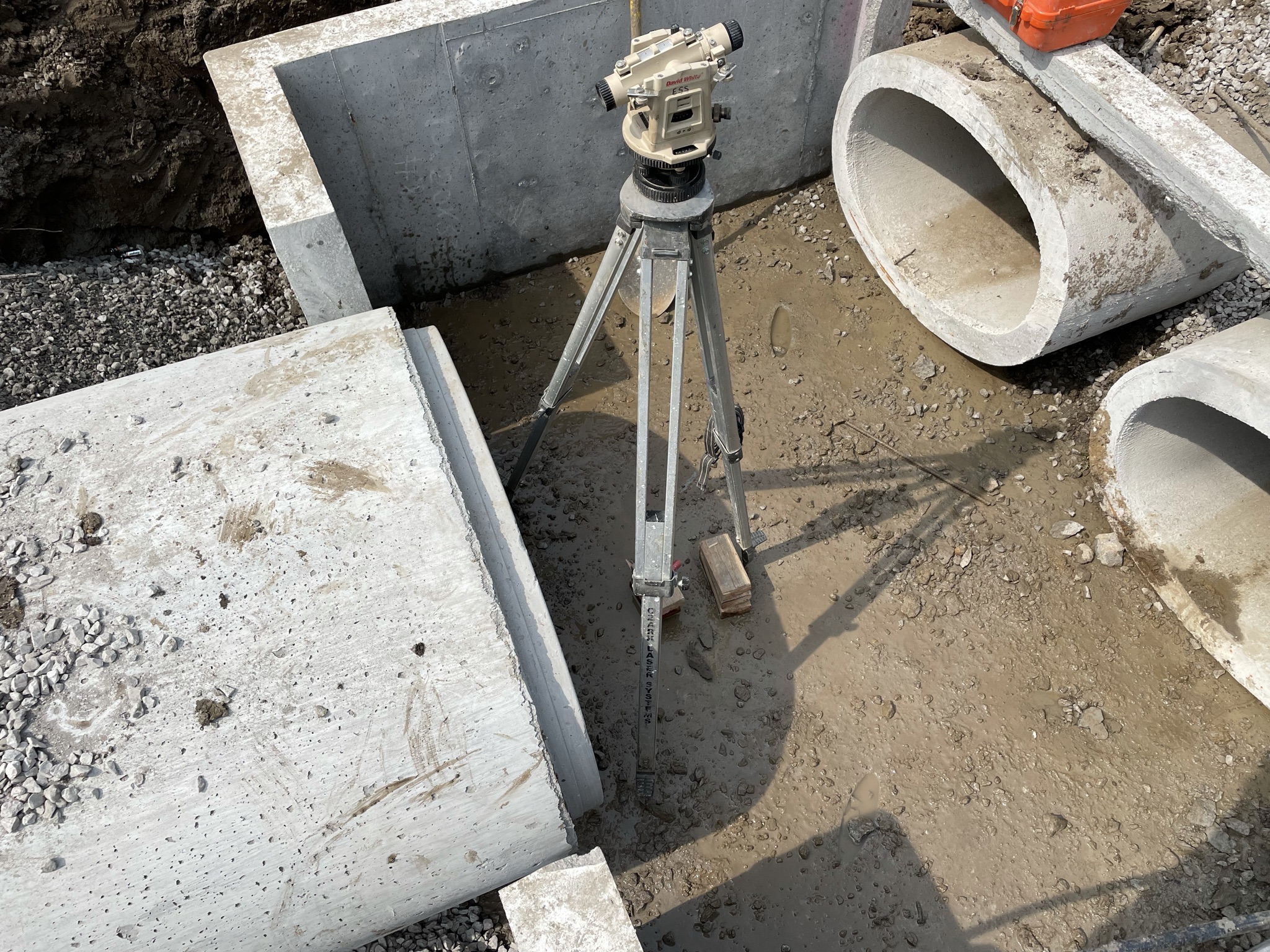

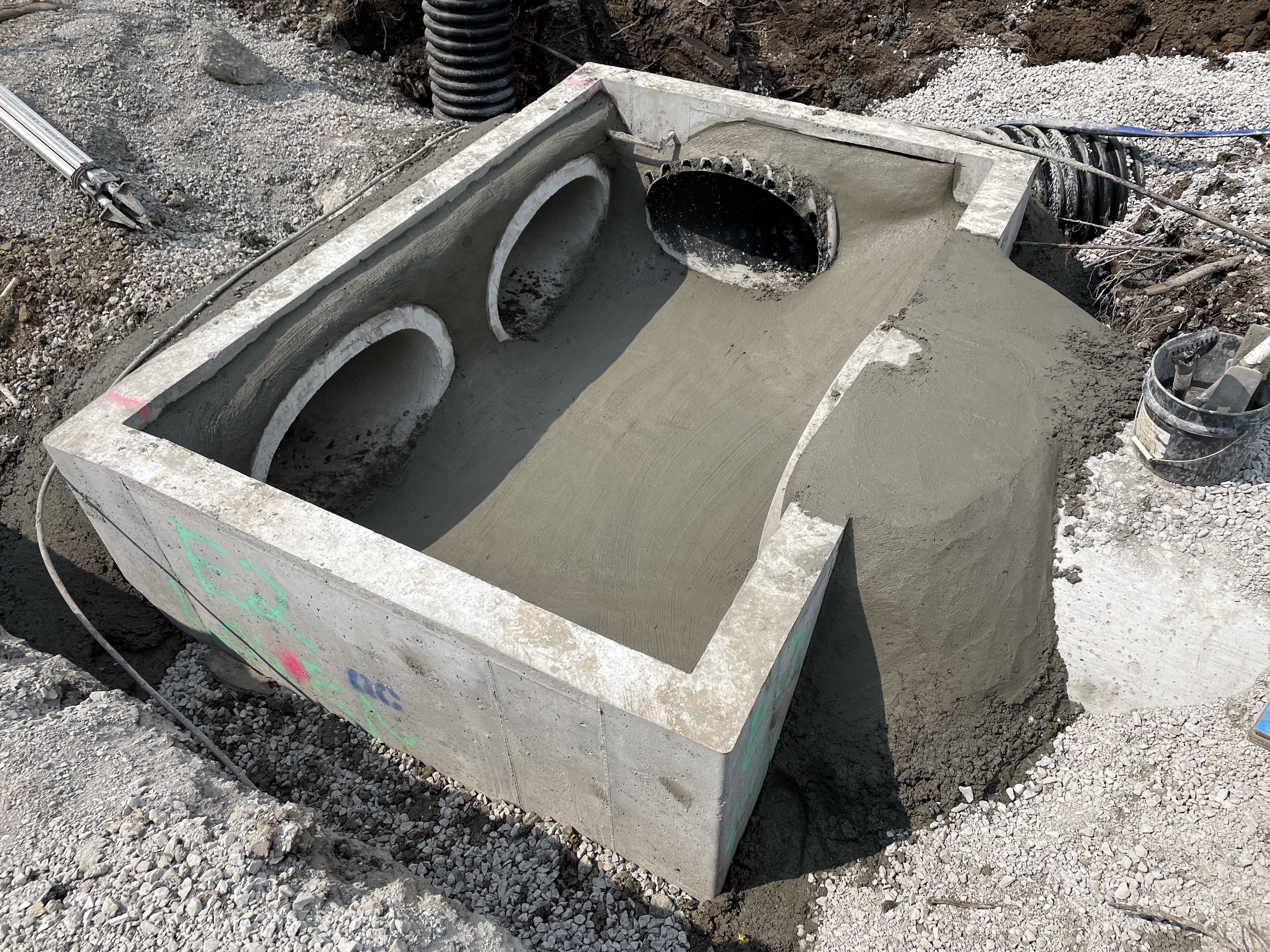

11/21/2022 SWP 2021 5290 Box E-1 B
11/21/2022 SWP 2021 5290 Box E-2 A
11/21/2022 SWP 2021 5290 Box E-2 C
11/21/2022 SWP 2021 5290 Box E-1 A
11/21/2022 SWP 2021 5290 Box E-2 B
11/21/2022 SWP 2021 5290 Box E-3 F
11/21/2022 SWP 2021 5290 Box E-3 E
11/21/2022 SWP 2021 5290 Box E-3 G
11/21/2022 SWP 2021 5290 Box E-2 D
11/21/2022 SWP 2021 5290 Box E-3 H
11/21/2022 SWP 2021 5290 Box E-3 I
11/21/2022 SWP 2021 5290 Box E-3 D
11/21/2022 SWP 2021 5290 Box E-3 J
11/21/2022 SWP 2021 5290 Box E-3 K
11/21/2022 SWP 2021 5290 Box E-1 C
11/21/2022 SWP 2021 5290 Box E-3 A
11/21/2022 SWP 2021 5290 Box E-3 B
11/21/2022 SWP 2021 5290 Box E-3 C
11/21/2022 SWP 2021 5290 Box E-3 hole
11/21/2022 SWP 2021 5290 Box E-3 M
11/21/2022 SWP 2021 5290 Box E-3 L
11/21/2022 SWP 2021 5290 Box E-3 O
11/21/2022 SWP 2021 5290 Box E-3 N

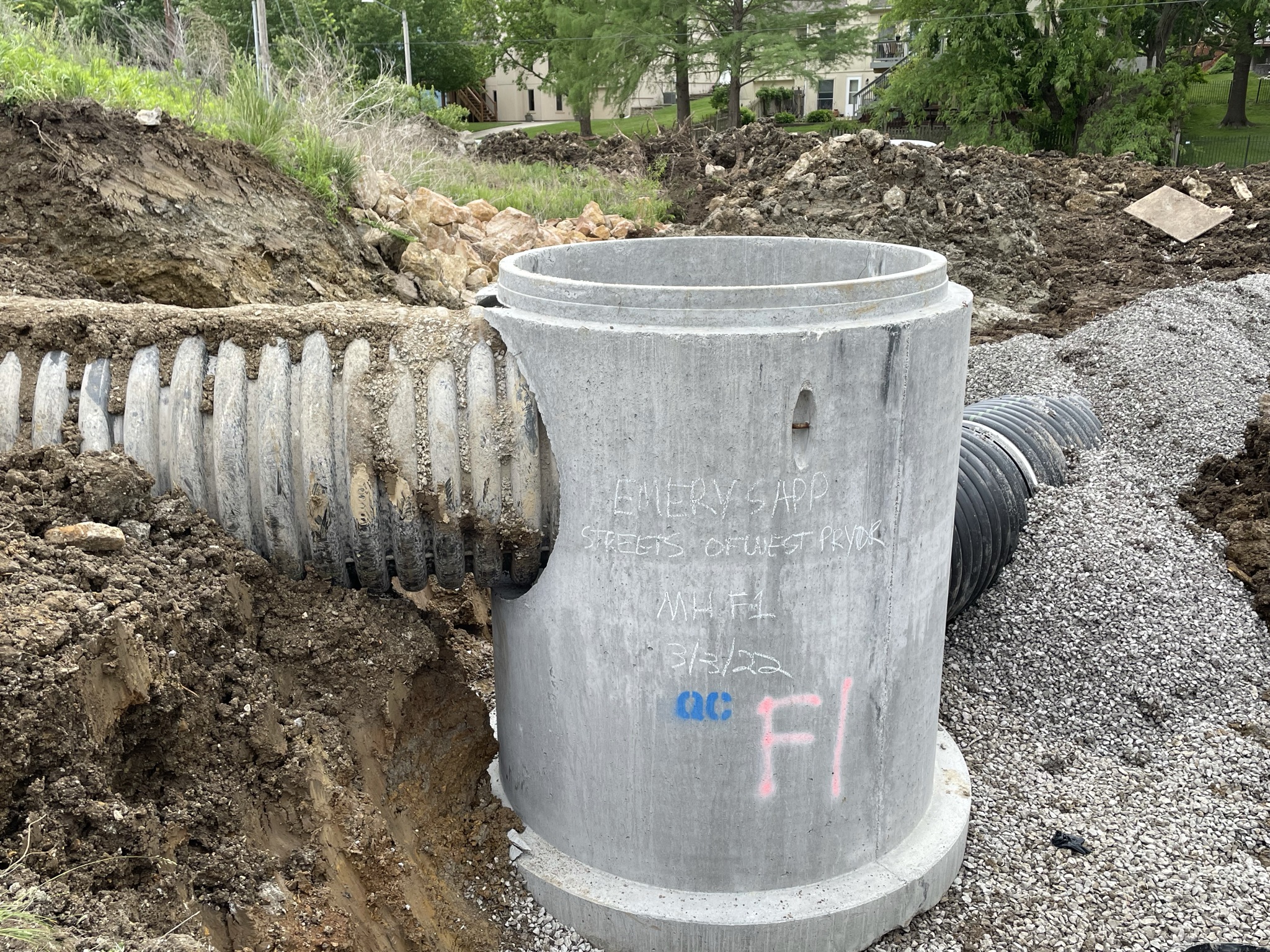

11/21/2022 SWP 2021 5290 Box F-1 B
11/21/2022 SWP 2021 5290 Box F-1 C
11/21/2022 SWP 2021 5290 Box F-1 D
11/21/2022 SWP 2021 5290 Box F-1 E
11/21/2022 SWP 2021 5290 Box F-1 I
11/21/2022 SWP 2021 5290 Box F-1 J
11/21/2022 SWP 2021 5290 Box F-1 K
11/21/2022 SWP 2021 5290 Box F-1 M
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 C
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 D
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 Repaired
11/21/2022 SWP 2021 5290 E-2 Set 1
11/21/2022 SWP 2021 5290 E-2 Set 2
11/21/2022 SWP 2021 5290 Box F-1 L
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 B
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 E
11/21/2022 SWP 2021 5290 damaged pipe section 8, between E-2 and E-3 A
11/21/2022 SWP 2021 5290 Box F-1 A
11/21/2022 SWP 2021 5290 Box F-1 F
11/21/2022 SWP 2021 5290 Box F-1 G
11/21/2022 SWP 2021 5290 Box F-1 H
11/21/2022 SWP 2021 5290 E-2 Base 1
11/21/2022 SWP 2021 5290 E-2 Base 2
11/21/2022 SWP 2021 5290 E-2 Base 3
11/21/2022 SWP 2021 5290 Box F-1 N
11/21/2022 SWP 2021 5290 E-4 B
11/21/2022 SWP 2021 5290 E-4 A
11/21/2022 SWP 2021 5290 wedging 1
11/21/2022 SWP 2021 5290 trench E-3 to F-1 C

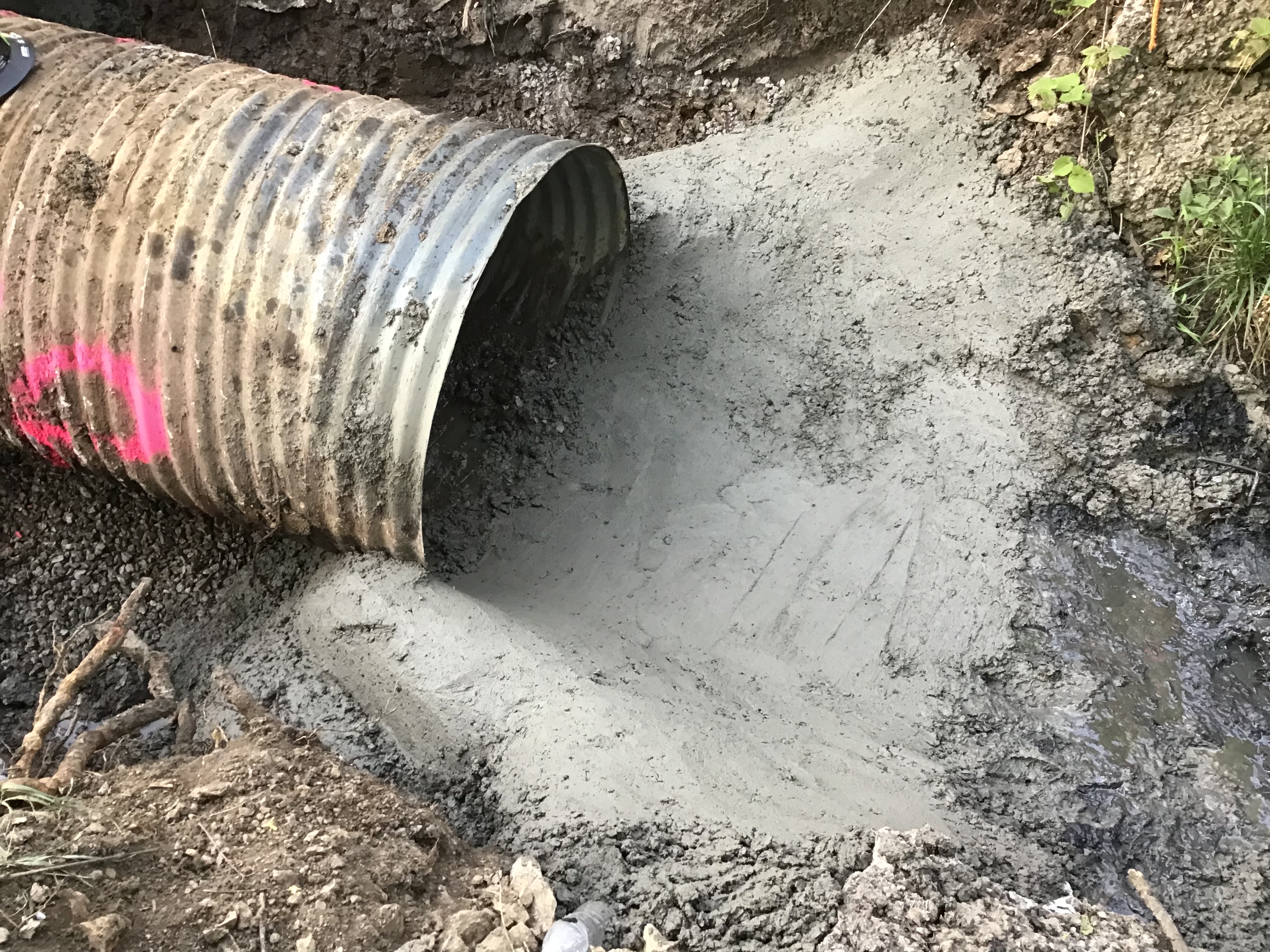

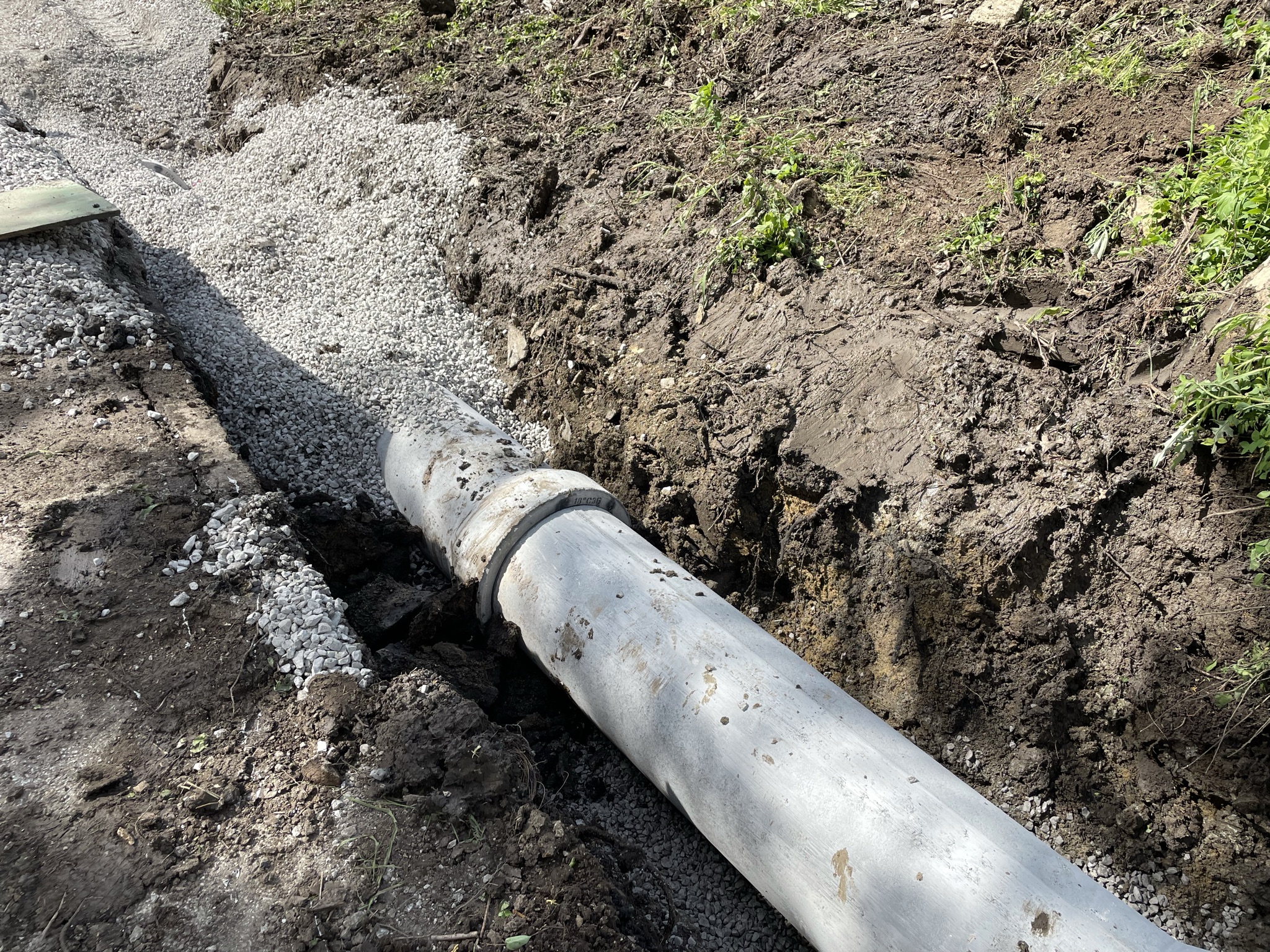

11/21/2022 SWP 2021 5290 pipe between E-2 and E-3
11/21/2022 SWP 2021 5290 pipe between E-1 and E-2
11/21/2022 SWP 2021 5290 Pipe between Box E-1 E-2
11/21/2022 SWP 2021 5290 pipe between E-2 and E-3 B
11/21/2022 SWP 2021 5290 pipe coming to E-3
11/21/2022 SWP 2021 5290 E-4 D
11/21/2022 SWP 2021 5290 trench E-3 to F-1 B
11/21/2022 SWP 2021 5290 E-4 C
11/21/2022 SWP 2021 5290 trench E-3 to F-1 A
11/21/2022 SWP 2021 5290 pipe E-3 to E-4
11/21/2022 SWP 2021 5290 wedging 2
04/27/2023 Letter DE-Punch List
04/27/2023 Streets of West Pryor-Phase II Lowentstein Drive Improvements Punch List
03/01/2024 SOWP Phase II Lowenstein Improvements 3 Yera Maintenance Bond - X
03/01/2024 SOWP Phase II Lowenstein Improvements Final Affidavit and Agreement - X
03/01/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
