Permit Application Status

PRRES20211948

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRRES20211948
Building Permit - Residential
Certificate of Occupancy
ACH DEVELOPMENT LLC
NEW SINGLE FAMILY
NEW HOUSE - ENG. FLOOR SYSTEM (DEFERRED) - FINISHED AND UNFINISHED BASEMENT - COVERED DECK
04/21/2021
07/26/2021
12/12/2021
09/20/2022
Locations
Contacts
ACH DEVELOPMENT LLC, Address:3170 NE CARNEGIE DR STE 400
CAPITAL CONSTRUCTION SERVICES LLC, Address:2642 NE HAGAN RD, Phone:(816) 875-0018
DROTHFUSS@CAPITALCONST.COM
UNITED HEATING & COOLING, Address:301 DUCK RD, Phone:(816) 761-5262
INHOME SYSTEMS LLC, Address:510 MISSION RD SW, Phone:(816) 372-0483
A BRIGHT PLUMBING LLC, Address:201 NE WOODBURY DR, Phone:(816) 867-4540
Reviews
Review Type Outcome Est. Completion Date Completed
Plot Plan Review Approved 06/17/2021 06/15/2021
Brandon Kalwei
Residential Plan Review Approved 06/17/2021 06/15/2021
Brandon Kalwei
Residential Plan Review Rejected 04/26/2021 04/22/2021
Brandon Kalwei
Misc
Corrective Action Required
04/22/2021

Plans show walkout basement elevation, plot plan and MDP show daylight. need to change the plans to daylight or have stamped and sealed letter stating that walkout is acceptable.
Plot Plan Review Approved 04/26/2021 04/22/2021
Brandon Kalwei
Fees
Paid Fees Amount Paid Owing Date Paid
Valuation Fee New Single Family $1,180.88 $1,180.88 Paid 07/22/2021
8331507-Sewer Connection Fee $390.00 $390.00 Paid 07/22/2021
Right of Way Permit Fee $80.00 $80.00 Paid 07/22/2021
Residential Excise Tax Fee $1,077.12 $1,077.12 Paid 07/22/2021
Water Tap Fee $3,581.00 $3,581.00 Paid 07/22/2021
Water Meter Fee $455.54 $455.54 Paid 07/22/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Footing Inspection - Residential Passed 8/2/2021 (10:45) 8/2/2021 08/02/2021
Underslab Plumbing Inspection - Residential Passed 9/10/2021 09/10/2021
Sewer Service Inspection - R Failed 10/8/2021 (9:15) 10/8/2021 10/08/2021
Misc
Corrective Action Required
10/08/2021
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Erosion Control Inspection Residential Failed 10/11/2021 10/11/2021
DCM2 ESC DEFICIENT INSTALLATION
Corrective Action Required
10/11/2021
DEFICIENT EROSION CONTROL INSTALLATION. NO FURTHER INSPECTIONS UNTIL ADEQUATE EROSION CONTROL PROVIDED.
Water Service Inspection - R Passed 10/11/2021 (8:00) 10/11/2021 10/11/2021
Sewer Service Inspection - R Failed 10/8/2021 (11:30) 10/8/2021 10/14/2021
Misc
Corrective Action Required
10/14/2021
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
10/14/2021
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
10/14/2021
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Sewer Service Inspection - R Failed 10/25/2021 10/25/2021 10/25/2021
Misc
Corrective Action Required
10/14/2021
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
10/14/2021
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
10/14/2021
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Sewer Service Inspection - R Failed 11/18/2021 11/18/2021 11/18/2021
Misc
Corrective Action Required
10/25/2021
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
10/25/2021
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
10/25/2021
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Miscellaneous Correction
Corrective Action Required
11/18/2021
11-18-21 10:11am AN original sewer stub still has NOT been removed.
All Rough Inspection - Residential Failed 2/9/2022 2/9/2022 02/09/2022
Misc
Corrective Action Required
02/09/2022
-Strap and nail top plates lapped less than two ft at master bedroom/bath wall intersection -Wall outside master bedroom, secure wiring min 1.25” away from stud nail surface; Fb this wall from roof -Install (3)2x4 stud support for lvl beam at angled wall and full support to grade beam below -Protect wiring at great room bottom wall plate; protect at kitchen wall ; at front bathroom wall corner; at east basement bedroom door wall top plate -Complete b-vent and provide min 1” clearance to combustible -Fb butler pantry wall -Nail joist hanger at bottom stair landing -Parallel electrical wiring inside return air space at west basement bedroom -Fb wall from ceiling space at west basement bedroom closet -Provide full support underneath lvl beams point load near b-vent -Seal all penetrations of ceiling return air space -Double joists under kitchen island -Provide floor layout plan **OK TO INSULATE
Electrical Service Inspection Passed 2/9/2022 2/9/2022 02/09/2022
Gas Service Inspection - Residential Passed 2/9/2022 2/9/2022 02/09/2022
All Rough Inspection - Residential Failed 2/22/2022 2/22/2022 02/22/2022
Misc
Corrective Action Required
02/09/2022
-Complete b-vent and provide min 1” clearance to combustible **Install insulation shield for b-vent in attic; close the excessive gap at fire stop
All Rough Inspection - Residential Passed 02/23/2022
Misc
Resolved
02/23/2022
-Complete b-vent and provide min 1” clearance to combustible **Install insulation shield for b-vent in attic; close the excessive gap at fire stop
Sewer Service Inspection - R Failed 04/08/2022
Misc
Corrective Action Required
11/18/2021
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
11/18/2021
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
11/18/2021
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Miscellaneous Correction
Corrective Action Required
11/18/2021
11-18-21 10:11am AN original sewer stub still has NOT been removed.
Miscellaneous Correction
Corrective Action Required
04/08/2022
4-8-22 AN original sewer stub still needs to be removed. You need to use max adapters!
Piers/Caissons Inspection - Residential Passed 4/12/2022 (8:15) 4/12/2022 04/12/2022
Sewer Service Inspection - R Partial 04/19/2022
Misc
Corrective Action Required
04/08/2022
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
04/08/2022
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
04/08/2022
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Miscellaneous Correction
Corrective Action Required
04/08/2022
11-18-21 10:11am AN original sewer stub still has NOT been removed.
Miscellaneous Correction
Corrective Action Required
04/08/2022
4-8-22 AN original sewer stub still needs to be removed. You need to use max adapters!
Misc
Informational
04/19/2022
4-19-22 AN plumber is at the site and they have began to dig up the sewer stub so they can abandon it. I did inform them that they need to use max adapters
Sewer Service Inspection - R Passed 04/20/2022
Misc
Corrective Action Required
04/19/2022
House sewer not connected to the stub due to higher elevation. House sewer is now connected directly to the wye connection to main. Have Field Service inspect the wye and abandoned sewer stub
Misc
Corrective Action Required
04/19/2022
10-8-21 1:50 AN Spoke with plumber about the issue and he had to install a new wye, because the existing stub coming out of the main would have been to high for the sewer coming out of the house.
Misc
Corrective Action Required
04/19/2022
10-14-21 AN -Wye and stub was installed into the main without getting approval from the city. -Need to verify that a trench check and tracer wire was installed. -contractor abandoned the original stub and it needs to be REMOVED. -also need the exact location of the new wye between two manholes. -building sewer stubs being disconnected from the sewer main shall be disconnected by the Water Utilities Department, after the contractor has provided access to the sewer main via an OSHA compliant excavation with proper shoring as necessary.
Miscellaneous Correction
Corrective Action Required
04/19/2022
11-18-21 10:11am AN original sewer stub still has NOT been removed.
Miscellaneous Correction
Corrective Action Required
04/19/2022
4-8-22 AN original sewer stub still needs to be removed. You need to use max adapters!
Misc
Informational
04/19/2022
4-19-22 AN plumber is at the site and they have began to dig up the sewer stub so they can abandon it. I did inform them that they need to use max adapters
Misc
Informational
04/20/2022
4-20-22 AN plumber abandoned the the sewer stub and used the max adapters . Pic attached.
Driveway Inspection Partial 5/11/2022 5/11/2022 05/11/2022
Misc
Informational
05/11/2022
5-11-22 AN forms are in place and aggregate is present and compacted
Driveway Inspection Passed 5/16/2022 5/16/2022 05/16/2022
Misc
Informational
05/11/2022
5-11-22 AN forms are in place and aggregate is present and compacted
Misc
Informational
05/16/2022
5-16-22 AN driveway looks good and has expansion joints at curb and right of way. Meets Ada spec
Sidewalk Inspection Partial 6/23/2022 6/23/2022 06/23/2022
Misc
Informational
06/23/2022
6-23-22 AN forms are in place and aggregate is present and compacted
Sidewalk Inspection Partial 6/27/2022 6/27/2022 06/30/2022
Misc
Informational
06/23/2022
6-23-22 AN forms are in place and aggregate is present and compacted
Misc
Informational
06/30/2022
6-30-22 AN. Sidewalk looks good and meets Ada spec
Sidewalk Inspection Passed 06/30/2022
Misc
Informational
06/30/2022
6-23-22 AN forms are in place and aggregate is present and compacted
Misc
Informational
06/30/2022
6-30-22 AN. Sidewalk looks good and meets Ada spec
Erosion Control Inspection Residential Passed 08/15/2022
DCM2 ESC DEFICIENT INSTALLATION
Resolved
08/15/2022
DEFICIENT EROSION CONTROL INSTALLATION. NO FURTHER INSPECTIONS UNTIL ADEQUATE EROSION CONTROL PROVIDED.
Occupancy Inspection - Codes Residential Failed 8/15/2022 8/15/2022 08/15/2022
Misc
Corrective Action Required
08/15/2022
-Obtain lawn irrigation permit and submit backflow valve test report to city -Sewer manhole buried -Provide min 6” clearance from trim to grade at rear window -Deck posts are not notched for beam attachments per code. Two 1/2” through bolts (or equivalent) are required at each deck beam-post connection. See plan for details. Have engineer address -Screw the AC electrical terminal cover -Provide sewer tracer wire port at grade -Install water heater P/T discharge pipe down to within 6” of floor
Occupancy Inspection - Codes Residential Full C of O 9/20/2022 9/20/2022 09/20/2022
Misc
Resolved
09/20/2022
-Screw the AC electrical terminal cover -Provide sewer tracer wire port at grade -Install water heater P/T discharge pipe down to within 6” of floor
Documents & Images
Date Uploaded File Type Document Name
04/21/2021 Application Form APPLICATION
04/22/2021 Letter Codes Residential Plan Review
04/22/2021 Plot Plan APPROVED PLOT PLAN
06/15/2021 Approved Plans APPROVED PLANS
07/22/2021 Permit DS Building Permit
07/22/2021 Receipt Receipt for transaction:2021-005864
07/26/2021 Permit DS Building Permit
08/02/2021 Letter INSPECTION SUMMARY
09/10/2021 Letter INSPECTION SUMMARY
10/08/2021 Letter INSPECTION SUMMARY
10/08/2021 Letter INSPECTION SUMMARY

10/08/2021 New wye 1.jpeg

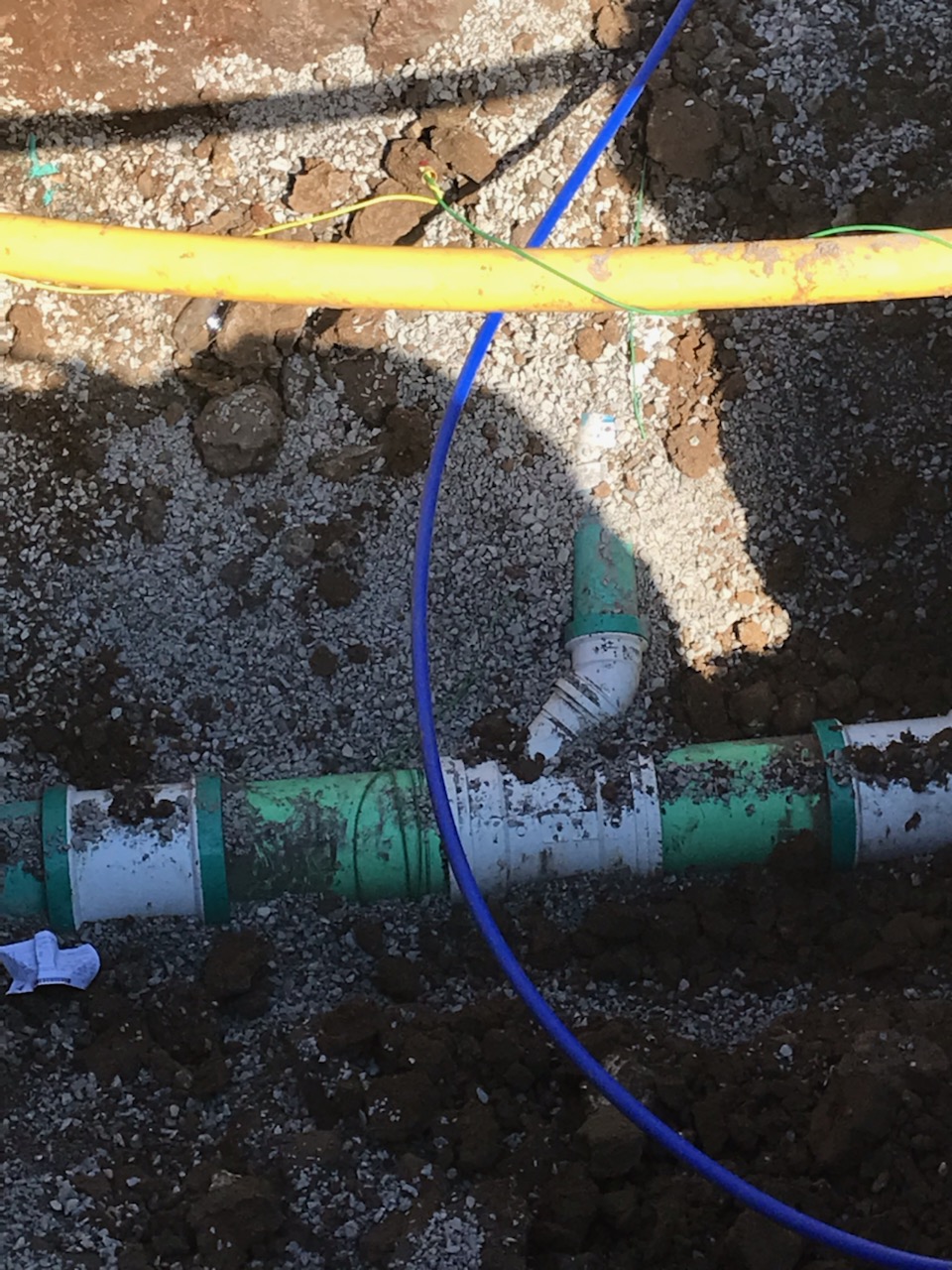

10/08/2021 New wye 2.jpeg
10/11/2021 Letter INSPECTION SUMMARY
10/11/2021 Letter INSPECTION SUMMARY
10/14/2021 Letter INSPECTION SUMMARY
10/14/2021 Letter INSPECTION SUMMARY
10/25/2021 Letter INSPECTION SUMMARY
11/18/2021 Letter INSPECTION SUMMARY
02/09/2022 Letter INSPECTION SUMMARY
02/09/2022 Letter INSPECTION SUMMARY
02/09/2022 Letter INSPECTION SUMMARY
02/09/2022 Lot #317-TPR I-Joist Layout
02/22/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
04/08/2022 Letter INSPECTION SUMMARY
04/12/2022 Letter INSPECTION SUMMARY
04/19/2022 Letter INSPECTION SUMMARY

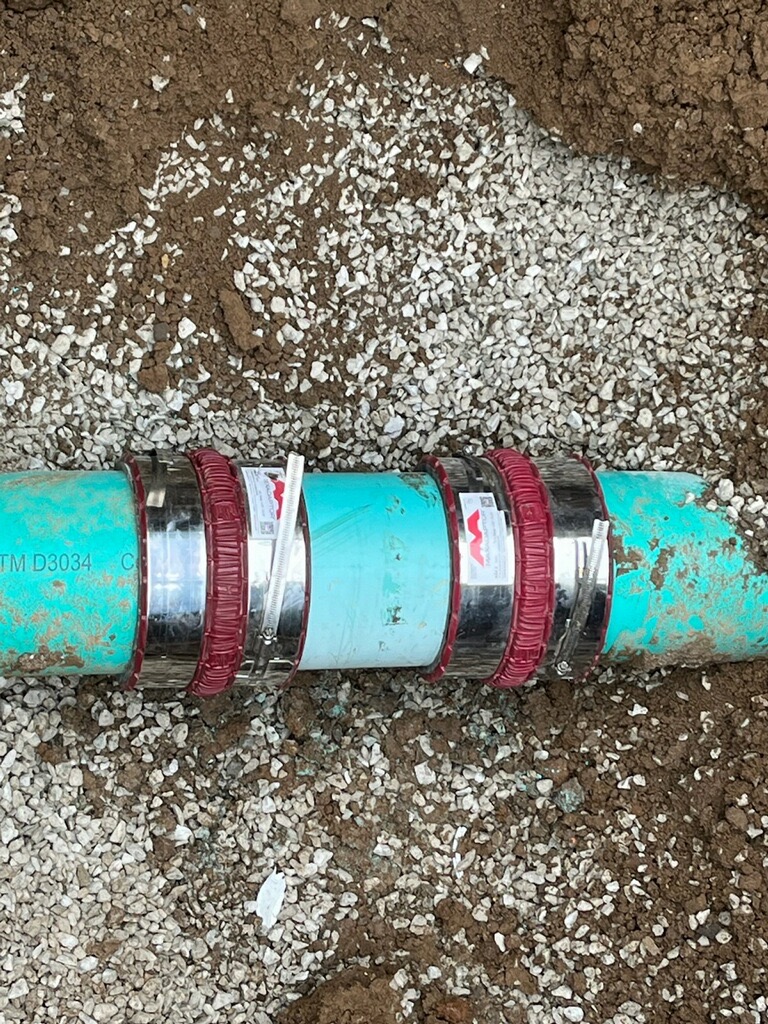

04/20/2022 Removed sewer stub and wye
04/20/2022 Letter INSPECTION SUMMARY
05/11/2022 Letter INSPECTION SUMMARY
05/16/2022 Letter INSPECTION SUMMARY
06/23/2022 Letter INSPECTION SUMMARY
06/30/2022 Letter INSPECTION SUMMARY
06/30/2022 Letter INSPECTION SUMMARY
08/15/2022 Letter INSPECTION SUMMARY
08/15/2022 Letter INSPECTION SUMMARY
09/20/2022 Letter Field Certificate of Occupancy
09/20/2022 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
