Permit Application Status

PRSUBD20224162


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20224162
Public Infrastructure
Final Acceptance
1201 SW CORINTHIAN LLC
DEVELOPMENT COMPLETE
Lumberman's Row. Mass Grading & ESC, Public Sanitary, Streets, Storm & Mass Grading, Public Water.
08/26/2022
11/01/2024
Locations
Address
1205 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1209 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1213 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1221 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1225 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1229 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1241 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1240 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1232 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1228 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1224 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1220 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1216 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1212 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1208 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1204 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1200 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1237 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1245 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Address
1236 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Property
62430997700000000

Property
62430997800000000

Property
62430997500000000

Property
62430997400000000

Property
62430997300000000

Property
62430997200000000

Property
62430997100000000

Property
62430997000000000

Property
62430996900000000

Property
62430998000000000

Property
62430998100000000

Property
62430998200000000

Property
62430998300000000

Property
62430998400000000

Property
62430998500000000

Property
62430998600000000

Property
62430998700000000

Property
62430998800000000

Property
62430997600000000

Property
63600041600000000

Property
62430997600000000

Address
1201 SW CORINTHIAN LN, LEES SUMMIT, MO 64081

Contacts
RUSSELL PEARSON, Address:3152 GRANDSTAND CIR, Phone:(913) 735-9861
Scott Ready, Phone: 8169691225
DAVID RINNE, Address:SCHLAGEL ASSOCIATES
BUILDER'S STONE & MASONRY LLC, Address:9801 Legler Rd., Phone:(913) 764-4446
1201 SW CORINTHIAN LLC, Address:3152 SW GRANDSTAND CIR
NLV DEVELOPMENT COMPANY LLC, Address:3152 SW GRANDSTAND CIR
MERRITT FAMILY TRUST DATED 03/22/2011, Address:1213 SW CORINTHIAN LN
METCALF JEFFREY & TERRA*, Address:1409 SE WOODBINE DR
NEW LONGVIEW COMMUNITY ASSOCIATION INC, Address:5000 W 95TH ST STE 280
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 08/26/2022 08/30/2022
Scott Ready
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $2,403.45 $2,403.45 Paid 09/02/2022
Right of Way Permit Fee $85.00 $85.00 Paid 09/02/2022
Site Grading Fee $7,012.56 $7,012.56 Paid 08/30/2022
Storm Sewer Inspection Fee $2,978.34 $2,978.34 Paid 09/02/2022
Paved Surface Inspection Fee $6,385.43 $6,385.43 Paid 09/02/2022
Water Insp Fee $2,377.35 $2,377.35 Paid 11/23/2022
Water Test Fee $400.00 $400.00 Paid 11/23/2022
Right of Way Permit Fee $85.00 $85.00 Paid 11/23/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Partial 09/06/2022
Misc
Informational
09/06/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES
Grading/Excavation/Fill Inspection Partial 09/06/2022
Misc
Informational
09/06/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES
Grading/Excavation/Fill Inspection Partial 09/06/2022
Misc
Informational
09/06/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES
Grading/Excavation/Fill Inspection Partial 09/06/2022
Misc
Informational
09/06/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES
Grading/Excavation/Fill Inspection Partial 09/08/2022
Misc
Informational
09/06/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES
Grading/Excavation/Fill Inspection Partial 09/08/2022
Misc
Informational
09/08/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES
Grading/Excavation/Fill Inspection Partial 09/08/2022
Misc
Informational
09/08/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES
Grading/Excavation/Fill Inspection Partial 09/08/2022
Misc
Informational
09/08/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES
Grading/Excavation/Fill Inspection Partial 09/09/2022
Misc
Informational
09/08/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES
Grading/Excavation/Fill Inspection Partial 09/12/2022
Misc
Informational
09/09/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES
Erosion Control Inspection Partial 09/12/2022
Misc
Informational
09/06/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES
Erosion Control Inspection Partial 09/26/2022
Misc
Informational
09/12/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES
Grading/Excavation/Fill Inspection Partial 09/26/2022
Misc
Informational
09/12/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES
Sanitary Sewer Construction Inspection Partial 09/27/2022
Misc
Informational
09/27/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES
Erosion Control Inspection Partial 10/03/2022
Misc
Informational
09/26/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES
Grading/Excavation/Fill Inspection Partial 10/07/2022
Misc
Informational
09/26/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES
Erosion Control Inspection Partial 10/11/2022
Misc
Informational
10/03/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES
Erosion Control Inspection Partial 10/19/2022
Misc
Informational
10/11/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES
Grading/Excavation/Fill Inspection Partial 10/19/2022
Misc
Informational
10/07/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES Bair crew working on grading site. Schlagel onsite verifying elevations on installed structures. 10/18/22 ES
Site Visit Partial 10/19/2022
Misc
Informational
10/19/2022
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES
Grading/Excavation/Fill Inspection Partial 10/28/2022
Misc
Informational
10/19/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES Bair crew working on grading site. Schlagel onsite verifying elevations on installed structures. 10/18/22 ES Bair crew cutting slop from top of road surfaces from rain even early in week. 10/26/22 ES
Erosion Control Inspection Partial 10/28/2022
Misc
Informational
10/19/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES
Sanitary Sewer Construction Inspection Partial 10/28/2022
Misc
Informational
09/27/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES
Sanitary - Material Verification Partial 10/29/2022
Misc
Informational
10/29/2022
Winwater delivered: 8" SDR26 pipe 6" SDR26 pipe 8"x6" SDR26 wye fittings 10/22/22 ES
Water - Material Verification Partial 10/29/2022
Misc
Informational
10/29/2022
Winwater delivered: 8" C900 pipe 6" C900 pipe Zinc stamped epoxy coated fittings(tees, bends, solid sleeves) Epoxy coated 6" and 8" gate valves Kennedy K81D fire hydrants Blue tracer wire and locator tape 10/27/22 ES
Storm - Material Verification Partial 10/29/2022
Misc
Informational
10/29/2022
Winwater delivered 15", 18" and 24" ADS storm pipe along with gaskets. 10/27/22 ES
Sanitary - Material Verification Partial 10/29/2022
Misc
Informational
10/29/2022
Winwater delivered: 8" SDR26 pipe 6" SDR26 pipe 8"x6" SDR26 wye fittings 10/22/22 ES PreTech delivered base, barrel, and cone sections for MH D-2 and D-3. 10/28/22 ES
Storm - Material Verification Partial 10/29/2022
Misc
Informational
10/29/2022
Winwater delivered 15", 18" and 24" ADS storm pipe along with gaskets. 10/27/22 ES PreTech delivered 24" RCP pipe and 24" RCP flared end section. 10/28/22 ES
Sanitary Sewer Construction Inspection Partial 10/29/2022
Misc
Informational
10/28/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES
Erosion Control Inspection Partial 10/31/2022
Misc
Informational
10/28/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES
Sanitary Sewer Construction Inspection Partial 10/31/2022
Misc
Informational
10/29/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES
Sanitary Sewer Construction Inspection Partial 10/31/2022
Misc
Informational
10/31/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES
Sanitary Sewer Construction Inspection Partial 10/31/2022
Misc
Informational
10/31/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES
Sanitary Sewer Construction Inspection Partial 11/01/2022
Misc
Informational
10/31/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction.
Sanitary Sewer Construction Inspection Partial 11/02/2022
Misc
Informational
11/01/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES
Sanitary Sewer Construction Inspection Partial 11/03/2022
Misc
Informational
11/02/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES
Erosion Control Inspection Partial 11/08/2022
Misc
Informational
10/31/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES
Sanitary Sewer Construction Inspection Partial 11/08/2022
Misc
Informational
11/03/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES
Erosion Control Inspection Partial 11/14/2022
Misc
Informational
11/08/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES
Sanitary Sewer Construction Inspection Partial 11/14/2022
Misc
Informational
11/08/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES Adam's crew completed D line, laying MH D-3 on 11/9. They worked on laying laterals on this line on 11/10 and began backfilling main trench with CFS onsite performing compaction testing. 11/11/22 ES
Storm Sewer Construction Inspection Partial 11/14/2022
Misc
Informational
11/14/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES
Sanitary Sewer Construction Inspection Partial 11/14/2022
Misc
Informational
11/14/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES Adam's crew completed D line, laying MH D-3 on 11/9. They worked on laying laterals on this line on 11/10 and began backfilling main trench with CFS onsite performing compaction testing. 11/11/22 ES
Sanitary Sewer Construction Inspection Partial 11/14/2022
Misc
Informational
11/14/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES Adam's crew completed D line, laying MH D-3 on 11/9. They worked on laying laterals on this line on 11/10 and began backfilling main trench with CFS onsite performing compaction testing. 11/11/22 ES Poured ditch checks on all 8 services, and poured inverts in MH D-2 and D-3. 11/14/22 ES
Storm Sewer Construction Inspection Partial 11/16/2022
Misc
Informational
11/14/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES
Sanitary Sewer Construction Inspection Partial 11/18/2022
Misc
Informational
11/14/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES Adam's crew completed D line, laying MH D-3 on 11/9. They worked on laying laterals on this line on 11/10 and began backfilling main trench with CFS onsite performing compaction testing. 11/11/22 ES Poured ditch checks on all 8 services, and poured inverts in MH D-2 and D-3. 11/14/22 ES Bair crew working on backfilling Sanitary trench line. pulled frozen top layer off and began filling with inner layers of backfill. 11/18/22 ES
Grading/Excavation/Fill Inspection Partial 11/18/2022
Misc
Informational
10/28/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES Bair crew working on grading site. Schlagel onsite verifying elevations on installed structures. 10/18/22 ES Bair crew cutting slop from top of road surfaces from rain even early in week. 10/26/22 ES Bair crew working on backfilling Sanitary trench line. pulled frozen top layer off and began filling with inner layers of backfill. 11/18/22 ES
Storm Sewer Construction Inspection Partial 11/18/2022
Misc
Informational
11/16/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES
Erosion Control Inspection Partial 11/21/2022
Misc
Informational
11/14/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES
Storm Sewer Construction Inspection Partial 11/29/2022
Misc
Informational
11/18/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1602. Correct bedding was placed.
Storm Sewer Construction Inspection Partial 12/01/2022
Misc
Informational
11/29/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure.
Storm Sewer Construction Inspection Partial 12/01/2022
Misc
Informational
12/01/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801.
Storm Sewer Construction Inspection Partial 12/02/2022
Misc
Informational
12/01/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602.
Storm Sewer Construction Inspection Partial 12/02/2022
Misc
Informational
12/02/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602.
Storm Sewer Construction Inspection Partial 12/06/2022
Misc
Informational
12/02/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604.
Storm Sewer Construction Inspection Partial 12/07/2022
Misc
Informational
12/06/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701.
Storm Sewer Construction Inspection Partial 12/08/2022
Misc
Informational
12/07/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material.
Storm Sewer Construction Inspection Partial 12/09/2022
Misc
Informational
12/08/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured.
Erosion Control Inspection Partial 12/12/2022
Misc
Informational
11/21/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order.
Storm Sewer Construction Inspection Partial 12/12/2022
Misc
Informational
12/09/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605.
Water Line - Construction Inspection Partial 12/20/2022
Misc
Informational
12/20/2022
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow.
Erosion Control Inspection Partial 12/20/2022
Misc
Informational
12/12/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order.
Site Visit Partial 12/27/2022
Misc
Informational
10/19/2022
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today.
Water Line - Construction Inspection Partial 12/28/2022
Misc
Informational
12/20/2022
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today.
Water Line - Construction Inspection Partial 12/29/2022
Misc
Informational
12/28/2022
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. The are planning to finish water line today.
Storm Sewer Construction Inspection Partial 12/29/2022
Misc
Informational
12/12/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605. 12-13-22 RH. Contractor placed Storm inlet 1605 and everything was backfilled. They then poured inlets for all of the storm placed. 12-29-22 RH. Contractor is placing storm box 1801. They will then run storm to 801 and 1802.
Water Line - Construction Inspection Partial 12/29/2022
Misc
Informational
12/29/2022
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4.
Erosion Control Inspection Partial 01/03/2023
Misc
Informational
12/20/2022
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order.
Water Line - Construction Inspection Partial 01/04/2023
Misc
Informational
12/29/2022
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 1-4-23 RH. No work being done on site due to rain event.
Water Line - Construction Inspection Partial 01/05/2023
Misc
Informational
01/04/2023
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 12-30-23 AN. Contractor placed the fire hydrant for Line 4 and completed that line. 1-4-23 RH. No work being done on site due to rain event. 1-5-23 RH. Contractor continued to place water line 2 from the T. Contractor will probably tie into exciting today.
Water Line - Construction Inspection Partial 01/06/2023
Misc
Informational
01/05/2023
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 12-30-23 AN. Contractor placed the fire hydrant for Line 4 and completed that line. 1-4-23 RH. No work being done on site due to rain event. 1-5-23 RH. Contractor continued to place water line 2 from the T. Contractor was able to get to station 2+60. Trench was dug out exposing tie in point. 1-6-23 RH. Contractor was not on site in the morning.
Water Line - Construction Inspection Partial 01/09/2023
Misc
Informational
01/06/2023
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 12-30-23 AN. Contractor placed the fire hydrant for Line 4 and completed that line. 1-4-23 RH. No work being done on site due to rain event. 1-5-23 RH. Contractor continued to place water line 2 from the T. Contractor was able to get to station 2+60. Trench was dug out exposing tie in point. 1-6-23 RH. Contractor was not on site in the morning. 1-9-23 RH. Contractor installed rest of water line making connection at 2+19 for water Line 2. Hydrant was assembled and placed at connection point.
Erosion Control Inspection Partial 01/09/2023
Misc
Informational
01/03/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order.
Storm Sewer Construction Inspection Partial 01/10/2023
Misc
Informational
12/29/2022
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605. 12-13-22 RH. Contractor placed Storm inlet 1605 and everything was backfilled. They then poured inlets for all of the storm placed. 12-29-22 RH. Contractor is placing storm box 1801. They will then run storm to 801 and 1802. 1-10-22 RH. Contractor is running the last of the storm from Storm Structure 1802 to 1803.
Storm Sewer Construction Inspection Partial 01/11/2023
Misc
Informational
01/10/2023
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605. 12-13-22 RH. Contractor placed Storm inlet 1605 and everything was backfilled. They then poured inlets for all of the storm placed. 12-29-22 RH. Contractor is placing storm box 1801. They will then run storm to 801 and 1802. 1-10-23 RH. Contractor is running the last of the storm from Storm Structure 1802 to 1803. 1-11-23 RH. Contractor placed storm structure 1803 in the AM. They are placing pipe to 1802 and then the storm structure will all be installed.
Storm Sewer Construction Inspection Partial 01/11/2023
Misc
Informational
01/11/2023
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605. 12-13-22 RH. Contractor placed Storm inlet 1605 and everything was backfilled. They then poured inlets for all of the storm placed. 12-29-22 RH. Contractor is placing storm box 1801. They will then run storm to 801 and 1802. 1-10-23 RH. Contractor is running the last of the storm from Storm Structure 1802 to 1803. 1-11-23 RH. Contractor placed storm structure 1803 in the AM. They are placing pipe to 1802 and then the storm structure will all be installed. All storm was tied in today. Inlets and collars will be poured on Monday.
Water Line - Construction Inspection Partial 01/24/2023
Misc
Informational
01/09/2023
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 12-30-23 AN. Contractor placed the fire hydrant for Line 4 and completed that line. 1-4-23 RH. No work being done on site due to rain event. 1-5-23 RH. Contractor continued to place water line 2 from the T. Contractor was able to get to station 2+60. Trench was dug out exposing tie in point. 1-6-23 RH. Contractor was not on site in the morning. 1-9-23 RH. Contractor installed rest of water line making connection at 2+19 for water Line 2. Hydrant was assembled and placed at connection point. 1-24-23 RH. Blow off Assembly was completed.
Water Line - Construction Inspection Passed 01/24/2023
Misc
Informational
01/24/2023
12-20-22 RH. Water line plans were reviewed with contractor to make sure everything matched up. They plan to start water line either today or tomorrow. 12-27-22 RH. Contractor installed water line 2 from 10+50 to 9+20. All bends were placed and thrust blocks were left open to be poured at a later time. 12-28-22 RH. Contractor is going to be continue from 9+20 place more line today to 8+37 where hydrant was placed. 12-29-22 RH. Contractor continues laying water line from 8+37 and continued placing water line to 6+00 in the AM. Contractor made it to the T at 5+27 and continued across the street towards Line 4. 12-30-23 AN. Contractor placed the fire hydrant for Line 4 and completed that line. 1-4-23 RH. No work being done on site due to rain event. 1-5-23 RH. Contractor continued to place water line 2 from the T. Contractor was able to get to station 2+60. Trench was dug out exposing tie in point. 1-6-23 RH. Contractor was not on site in the morning. 1-9-23 RH. Contractor installed rest of water line making connection at 2+19 for water Line 2. Hydrant was assembled and placed at connection point. 1-24-23 RH. Blow off Assembly was completed.
Water Line - Hydrostatic Test Partial 01/24/2023
Misc
Informational
01/24/2023
1-24-23 RH. Hydrostatic test was postponed due to pressure not getting to correct spec.
Erosion Control Inspection Partial 01/30/2023
Misc
Informational
01/09/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order.

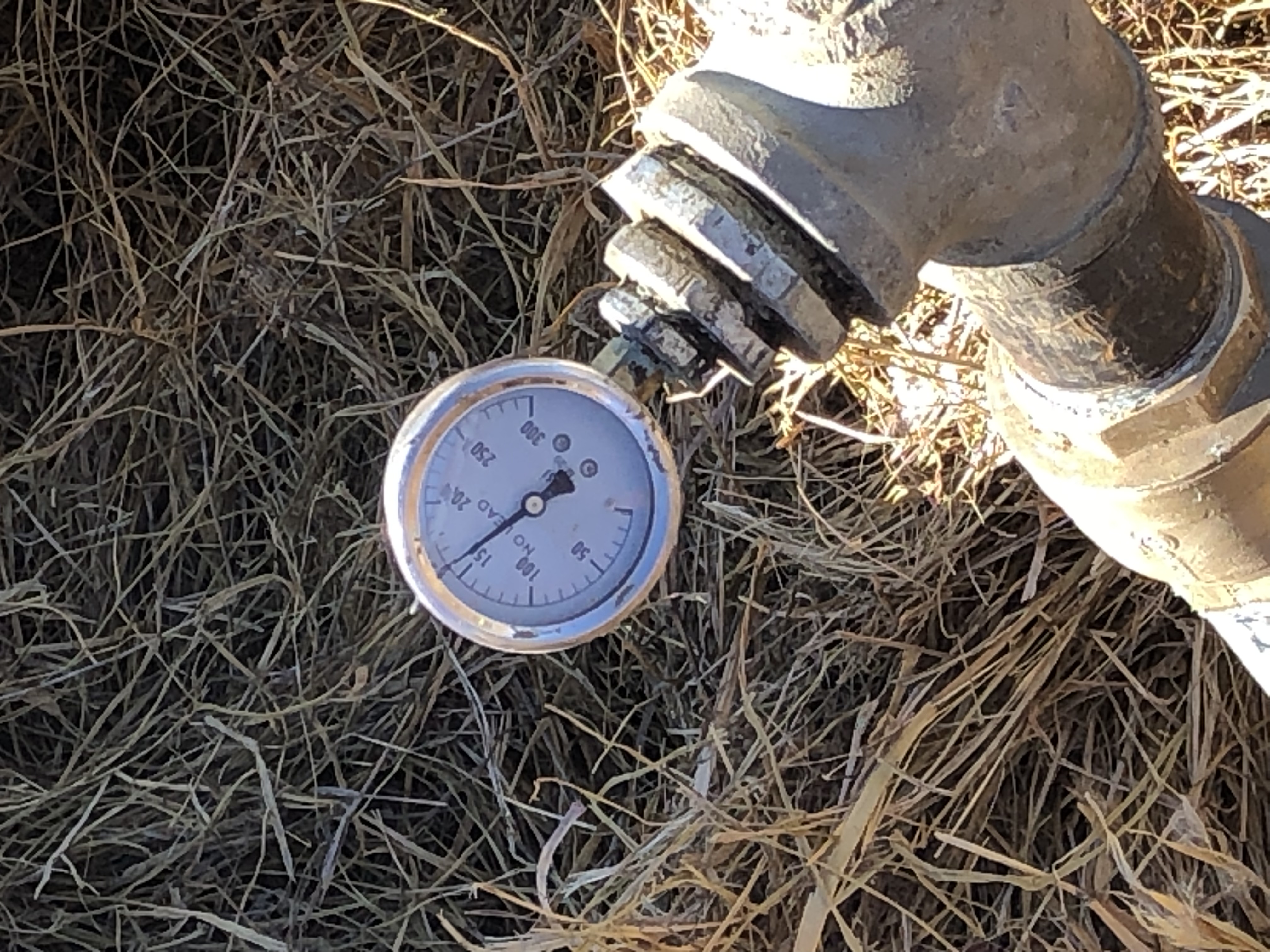

Water Line - Hydrostatic Test Failed 2/2/2023 2/2/2023 02/02/2023
Misc
Informational
01/24/2023
1-24-23 RH. Hydrostatic test was postponed due to pressure not getting to correct spec. 2-2-23 PS Hydrostatic test failed, Not able to reach correct pressure per spec

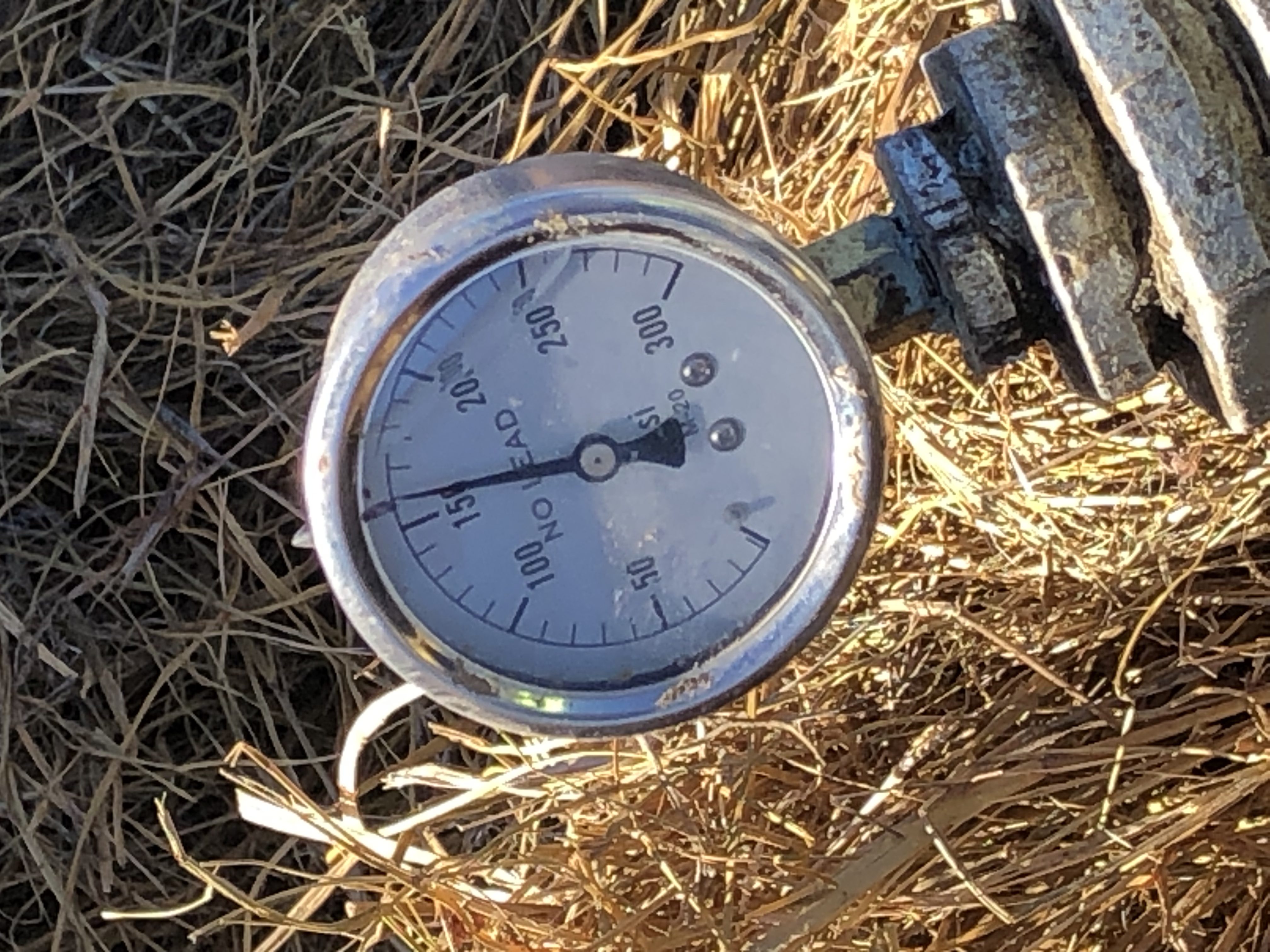

Water Line - Hydrostatic Test Passed 2/3/2023 2/3/2023 02/03/2023
Misc
Informational
02/02/2023
1-24-23 RH. Hydrostatic test was postponed due to pressure not getting to correct spec. 2-2-23 PS Hydrostatic test failed, Not able to reach correct pressure per spec 2-3-23 PS Hydrostatic test passed, test began at 10:20 am and ended at 12:20 pm
Sanitary Sewer Construction Inspection Passed 02/07/2023
Misc
Informational
11/18/2022
Left sanitary sewer stamped plans with Troy. 9/26/22 ES Adam's crew began laying out sewer pipe to begin construction in coming days. 10/27/22 ES Adam's crew started laying pipe out of MH D-1. Made it out 6 sticks of pipe and service for lot 16. 10/28/22 ES Adam and Troy's crews continued work on line D, made it 210 feet today, ~1 stick short of MH D-2. 10/29/22 ES Adam's crew got D-2 set and began laying pipe out of it. 10/31/22 ES 11-1-22 RH. Contractor was pouring inlets for Sanitary MH D-1. Talking to contractor they planed to pour D-2 inlet, after that they would continue to lay pipe toward D-3. Fill will start but not more than 8” due to no tester coming to site today to test compaction. Adam's crew continued working on D line. Had to pull MH D-2 and 5 sticks of pipe as MH was set high. After resetting MH they were able to get 8 sticks back in the ground. 11/2/22 ES Adam’s crew continued laying pipe on line D, installed 10 sticks of pipe. 11/3/22 ES Adam's crew continued on line D, had to take 3 sticks of pipe back out of ground as they floated in the rain event from 11/4. They got those sticks back in and cleaned out ditch to continue work. 11/7/22 ES Adam's crew completed D line, laying MH D-3 on 11/9. They worked on laying laterals on this line on 11/10 and began backfilling main trench with CFS onsite performing compaction testing. 11/11/22 ES Poured ditch checks on all 8 services, and poured inverts in MH D-2 and D-3. 11/14/22 ES Bair crew working on backfilling Sanitary trench line. pulled frozen top layer off and began filling with inner layers of backfill. 11/18/22 ES
Sanitary Sewer - Air Test Partial 02/07/2023
Misc
Informational
02/07/2023
2-7-23 RH Air test between C1 to D1- D2 to D1- D3-D2-
Sanitary Sewer - Air Test Passed 02/07/2023
Misc
Informational
02/07/2023
2-7-23 RH Air test between D2 to D1-Passed D3-D2-Passed
Sanitary Sewer - Vacuum Passed 02/07/2023
Misc
Informational
02/07/2023
2-7-23 RH. Vaccum test for Man hole D-2 and D-3 passed.
Water Line - Coliform Test 1 Partial 02/13/2023
Misc
Informational
02/13/2023
2-13-23 RH. Contractor is chlorinating the line and will let sit for 24 hours.
Water Line - Coliform Test 1 Partial 02/14/2023
Misc
Informational
02/13/2023
2-13-23 RH. Contractor is chlorinating the line and will let sit for 24 hours. 2-14-23 RH. Contractor plans to flush lines from 12-1pm due to the rain.
Water Line - Coliform Test 1 Partial 2/15/2023 2/15/2023 02/15/2023
Misc
Informational
02/14/2023
2-13-23 RH. Contractor is chlorinating the line and will let sit for 24 hours. 2-14-23 RH. Contractor plans to flush lines from 12-1pm due to the rain. 2-15-23 PS Collected (6) water samples for first testing and delivered to lab
Water Line - Coliform Test 1 Partial 02/16/2023
Misc
Informational
02/15/2023
2-13-23 RH. Contractor is chlorinating the line and will let sit for 24 hours. 2-14-23 RH. Contractor plans to flush lines from 12-1pm due to the rain. 2-15-23 PS Collected (6) water samples for first testing and delivered to lab 2-16-23 RH. Collectd 6 water samples for the second round of testing.
Water Line - Coliform Test 1 Passed 02/17/2023
Misc
Informational
02/16/2023
2-13-23 RH. Contractor is chlorinating the line and will let sit for 24 hours. 2-14-23 RH. Contractor plans to flush lines from 12-1pm due to the rain. 2-15-23 PS Collected (6) water samples for first testing and delivered to lab 2-16-23 RH. Collectd 6 water samples for the second round of testing. 2-17-23 RH. First round of samples passed Total Coliform Test.
Water Line - Coliform Test 2 Passed 02/21/2023
Misc
Informational
02/21/2023
2-21-23 RH. Second round of Total Coliform Tests passed.
Sanitary Sewer - Mandrel Partial 02/21/2023
Misc
Informational
02/21/2023
2-21-23 RH. Mandral will be pulled though lines MH D2 to D3 MH D2 to D1
Sanitary Sewer - Mandrel Partial 02/21/2023
Misc
Informational
02/21/2023
2-21-23 RH. Mandral will be pulled though lines MH D2 to D3 passed MH D2 to D1
Erosion Control Inspection Partial 2/22/2023 2/22/2023 02/22/2023
Misc
Informational
01/30/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order.
Sanitary Sewer - Mandrel Passed 02/23/2023
Misc
Informational
02/21/2023
2-21-23 RH. Mandral will be pulled though lines MH D2 to D3 passed 2-23-23 Mandral was pulled through MH D2 to D1 passed
Grading/Excavation/Fill Inspection Partial 02/24/2023
Misc
Informational
11/18/2022
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES Bair crew working on grading site. Schlagel onsite verifying elevations on installed structures. 10/18/22 ES Bair crew cutting slop from top of road surfaces from rain even early in week. 10/26/22 ES Bair crew working on backfilling Sanitary trench line. pulled frozen top layer off and began filling with inner layers of backfill. 11/18/22 ES 2-24-23 RH. Contractor is filling around storm field inlets to get to grade. Other filling and cleaning up site was occuring.
Erosion Control Inspection Partial 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
02/22/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order.
Erosion Control Inspection Partial 3/22/2023 3/22/2023 03/22/2023
Misc
Informational
03/17/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order.
Site Visit Partial 4/25/2023 4/25/2023 04/26/2023
Misc
Informational
12/27/2022
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes.
Erosion Control Inspection Partial 5/2/2023 5/2/2023 05/02/2023
Misc
Informational
03/22/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order
Pavement-Curb Construction Partial 5/5/2023 5/5/2023 05/05/2023
Misc
Informational
05/05/2023
5-5-23 RH. The curb for Lumbermans row is started to be strung. Contractor said they may not finish today due to rain.
Pavement-Stabilized Subgrade Partial 5/22/2023 5/22/2023 05/22/2023
Misc
Informational
05/22/2023
5-22-23 DP. Crew is currently installing Geogrid and compacting aggregate on both sides of Lumberman's Row.
Pavement-Stabilized Subgrade Partial 05/23/2023
Misc
Informational
05/22/2023
5-22-23 DP. Crew is currently installing Geogrid and compacting aggregate on both sides of Lumberman's Row. 5-23-23 DP. Crew is continuing to grade rock in preparation for a proof roll
Curb - Proof Roll Partial 5/30/2023 5/30/2023 05/31/2023
Misc
Informational
05/31/2023
5-31-23 DP. Proof roll for curb was performed and passed with 20 tons in the truck. It will need to be redone since it rained so much last night.
Erosion Control Inspection Partial 6/6/2023 6/6/2023 06/06/2023
Misc
Informational
05/02/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order
Curb - Proof Roll Partial 6/6/2023 6/6/2023 06/06/2023
Misc
Informational
05/31/2023
5-31-23 DP. Proof roll for curb was performed and passed with 20 tons in the truck. It will need to be redone since it rained so much last night. 6-6-23 DP. Crew is continuing to regrade for a proof roll after previous rain.
Pavement-Curb Construction Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/07/2023
6-7-23 DP. Crew is installing another drain pipe along the length of the curb
Install Street and Stop Signs Partial 6/7/2023 6/7/2023 06/07/2023
Misc
Informational
06/07/2023
6-7-23 DP. Streetwise is currently installing necessary street signs
Site Visit Partial 6/12/2023 6/12/2023 06/12/2023
Misc
Informational
04/26/2023
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb.
Curb - Proof Roll Partial 6/21/2023 6/21/2023 06/21/2023
Misc
Informational
06/06/2023
5-31-23 DP. Proof roll for curb was performed and passed with 20 tons in the truck. It will need to be redone since it rained so much last night. 6-6-23 DP. Crew is continuing to regrade for a proof roll after previous rain. 6-21-23 DP. Crew passed the proof roll with 20 ton certified load for curbs. They are planning on laying curb tomorrow.
Sanitary Sewer - Camera Test Partial 6/23/2023 6/23/2023 06/23/2023
Misc
Informational
06/23/2023
6-23-23 Problems with sanitary on 5th plat and off-site sanitary. The only problems with Lumberman's was mastic that needed trimmed. They are working on that today.
Pavement-Curb Construction Partial 6/23/2023 6/23/2023 06/23/2023
Misc
Informational
05/05/2023
5-5-23 RH. The curb for Lumbermans row is started to be strung. Contractor said they may not finish today due to rain. 6-23-23 DP. Curb has been poured. Fine grading for asphalt will be on monday.
Pavement-Surface Partial 6/28/2023 6/28/2023 06/28/2023
Misc
Informational
06/28/2023
6-27-23 DP. Crew laid 667 tons of type 5-01 Base asphalt
Pavement-Surface Partial 6/28/2023 6/28/2023 06/28/2023
Misc
Informational
06/28/2023
6-27-23 DP. Crew laid 667 tons of type 5-01 Base asphalt 6-28-23 DP. Crew installed and finished surface asphalt on Lumberman's Row today. They put down 379.34 tons of type 5-01 surface.
Curb - Proof Roll Passed 06/28/2023
Misc
Informational
06/21/2023
5-31-23 DP. Proof roll for curb was performed and passed with 20 tons in the truck. It will need to be redone since it rained so much last night. 6-6-23 DP. Crew is continuing to regrade for a proof roll after previous rain. 6-21-23 DP. Crew passed the proof roll with 20 ton certified load for curbs. They are planning on laying curb tomorrow.
Erosion Control Inspection Partial 7/12/2023 7/12/2023 07/12/2023
Misc
Informational
06/06/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap.
Erosion Control Inspection Partial 7/18/2023 7/18/2023 07/18/2023
Misc
Informational
07/12/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Erosion Control Inspection Failed 7/24/2023 7/24/2023 07/24/2023
Misc
Informational
07/18/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
07/24/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated.
Erosion Control Inspection Partial 7/28/2023 7/28/2023 07/28/2023
Misc
Informational
07/24/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
07/24/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th.
Erosion Control Inspection Failed 8/3/2023 8/3/2023 08/03/2023
Misc
Informational
07/28/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
07/28/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better.
Erosion Control Inspection Failed 8/9/2023 8/9/2023 08/09/2023
Misc
Informational
08/03/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/03/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud.
Erosion Control Inspection Failed 8/14/2023 8/14/2023 08/14/2023
Misc
Informational
08/09/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/09/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas.
Erosion Control Inspection Partial 8/16/2023 8/16/2023 08/16/2023
Misc
Informational
08/14/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/14/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day.
Erosion Control Inspection Failed 8/17/2023 8/17/2023 08/17/2023
Misc
Informational
08/16/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/16/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas.
Erosion Control Inspection Failed 8/18/2023 8/18/2023 08/18/2023
Misc
Informational
08/17/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/17/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again.
Erosion Control Inspection Partial 8/24/2023 8/24/2023 08/24/2023
Misc
Informational
08/18/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/18/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order.
Erosion Control Inspection Partial 9/19/2023 9/19/2023 09/19/2023
Misc
Informational
08/24/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
08/24/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting.
Erosion Control Inspection Partial 10/3/2023 10/3/2023 10/03/2023
Misc
Informational
09/19/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
09/19/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order.
Water - Material Verification Passed 10/03/2023
Misc
Informational
10/29/2022
Winwater delivered: 8" C900 pipe 6" C900 pipe Zinc stamped epoxy coated fittings(tees, bends, solid sleeves) Epoxy coated 6" and 8" gate valves Kennedy K81D fire hydrants Blue tracer wire and locator tape 10/27/22 ES
Storm Sewer Construction Inspection Passed 10/03/2023
Misc
Informational
01/11/2023
Adam's crew began construction on line 1800. Cut a doghouse into existing box 801 and ran 5 sticks of 18" HDPE pipe out. Poured collar on pipe going into box 801. 11/14/22 ES Adam's crew began construction on line 1600. Set flared end section and began working towards box 1601. 11/16/22 ES Adam's crew put in 10 sticks of pipe on 11/16/22 and another 2 sticks today. 11/18/22 ES 11-28-22 RH. Crew continued to place stick of pipe for Line 1600 to 1601. Correct bedding was placed. 12-1-22 RH. Crew continues to lay pipe from 1600 to 1601 Storm structure. Storm Structure 1601 was placed. Crew will continue across the street to 1602 starting tomorrow and may set another storm inlet 1801. 12-2-22 RH. Crew continues to lay pipe coming from 1601 to 1602. Crew plans to place storm structure 1602. Structure 1602 was installed and crew began backfilling line 1600 to 1602. 12-5-22 RH. Crew placed inlet 1602 and backfilled piping between 1600 to 1602. 12-6-22 RH. Crew placed piping from 1602 to 1603. They will continue to lay pipe toward 1604. 12-7-22 RH. Contractor placed inlet 1604 and will continue to dig and place pipe towards 1701. Storm Structure 1701 was installed. 12-8-22 RH. Contractor is filling today around storm structures and compacting material. Collars were poured for storm structures. 12-9-22 RH. Contractor poured collars and inlets for open storm structures. Backfill began on the structures that had collars previously poured. 12-12-22 RH. Contractor is planning to continue to place storm pipe from 1604 to 1605. 12-13-22 RH. Contractor placed Storm inlet 1605 and everything was backfilled. They then poured inlets for all of the storm placed. 12-29-22 RH. Contractor is placing storm box 1801. They will then run storm to 801 and 1802. 1-10-23 RH. Contractor is running the last of the storm from Storm Structure 1802 to 1803. 1-11-23 RH. Contractor placed storm structure 1803 in the AM. They are placing pipe to 1802 and then the storm structure will all be installed. All storm was tied in today. Inlets and collars will be poured on Monday.
Storm - Material Verification Passed 10/03/2023
Misc
Informational
10/29/2022
Winwater delivered 15", 18" and 24" ADS storm pipe along with gaskets. 10/27/22 ES PreTech delivered 24" RCP pipe and 24" RCP flared end section. 10/28/22 ES
Sanitary Sewer - Camera Test Passed 10/03/2023
Misc
Informational
06/23/2023
6-23-23 Problems with sanitary on 5th plat and off-site sanitary. The only problems with Lumberman's was mastic that needed trimmed. They are working on that today.
Sanitary - Material Verification Passed 10/03/2023
Misc
Informational
10/29/2022
Winwater delivered: 8" SDR26 pipe 6" SDR26 pipe 8"x6" SDR26 wye fittings 10/22/22 ES PreTech delivered base, barrel, and cone sections for MH D-2 and D-3. 10/28/22 ES
Pavement-Surface Passed 10/03/2023
Misc
Informational
06/28/2023
6-27-23 DP. Crew laid 667 tons of type 5-01 Base asphalt 6-28-23 DP. Crew installed and finished surface asphalt on Lumberman's Row today. They put down 379.34 tons of type 5-01 surface.
Grading/Excavation/Fill Inspection Passed 5/23/2023 5/23/2023 10/03/2023
Misc
Informational
02/24/2023
Bair excavating onsite clearing trees/brush. 8/29/22 ES Bair excavating onsite clearing trees/brush. 8/30/22 ES Bair excavating onsite clearing trees/brush. 8/31/22 ES Bair excavating onsite clearing trees/brush. 9/1/22 ES Bair excavating started grading site. 9/2/22 ES Bair excavating grading site. 9/6/22 ES Bair excavating grading site. 9/7/22 ES Bair excavating grading site. 9/8/22 ES Bair Excavating grading site. 9/9/22 ES Bair Excavating grading site and running sheepsfoot compactor along future roadway areas.s 9/12/22 ES No grading or excavating activities being performed. Delivered approved plans for Grading, MDP, Street and Storm to Adam. 9/26/22 ES Adam's crew working on grading site. 10/7/22 ES Bair crew working on grading site. Schlagel onsite verifying elevations on installed structures. 10/18/22 ES Bair crew cutting slop from top of road surfaces from rain even early in week. 10/26/22 ES Bair crew working on backfilling Sanitary trench line. pulled frozen top layer off and began filling with inner layers of backfill. 11/18/22 ES 2-24-23 RH. Contractor is filling around storm field inlets to get to grade. Other filling and cleaning up site was occuring.
Install Street and Stop Signs Passed 10/03/2023
Misc
Informational
06/07/2023
6-7-23 DP. Streetwise is currently installing necessary street signs
Pavement-Curb Construction Passed 10/03/2023
Misc
Informational
06/23/2023
6-7-23 DP. Crew is installing another drain pipe along the length of the curb
Pavement-Stabilized Subgrade Passed 10/03/2023
Misc
Informational
05/23/2023
5-22-23 DP. Crew is currently installing Geogrid and compacting aggregate on both sides of Lumberman's Row. 5-23-23 DP. Crew is continuing to grade rock in preparation for a proof roll
Site Visit Partial 10/17/2023 10/17/2023 10/18/2023
Misc
Informational
06/12/2023
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row.
Erosion Control Inspection Partial 10/26/2023 10/26/2023 10/26/2023
Misc
Informational
10/03/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
10/03/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks.
Site Visit Partial 11/17/2023 11/17/2023 11/17/2023
Misc
Informational
10/18/2023
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin.
Erosion Control Inspection Partial 12/4/2023 12/4/2023 12/04/2023
Misc
Informational
10/26/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
10/26/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks. 12-4-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself.
Erosion Control Inspection Partial 12/20/2023 12/20/2023 12/20/2023
Misc
Informational
12/04/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
12/04/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks. 12-4-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself. 12-20-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself.
Erosion Control Inspection Partial 1/2/2024 1/2/2024 01/02/2024
Misc
Informational
12/20/2023
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
12/20/2023
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks. 12-4-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself. 12-20-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself.
Misc
Informational
01/02/2024
1-2-24 DP. ESC is currently in good working order. Only waiting for the 70% vegetation to establish itself before issuing final acceptance.
Site Visit Partial 1/18/2024 1/18/2024 01/18/2024
Misc
Informational
11/17/2023
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance.
Erosion Control Inspection Partial 3/25/2024 3/25/2024 03/25/2024
Misc
Informational
01/02/2024
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
01/02/2024
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks. 12-4-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself. 12-20-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself.
Misc
Informational
01/02/2024
1-2-24 DP. ESC is currently in good working order. Only waiting for the 70% vegetation to establish itself before issuing final acceptance. 3-25-24 DP. ESC is mostly in good working order. There is a small breech on the far north end. Will update after the rain tonight. As for vegetation, it's around 50-55% in the median, still fairly bare. Less than 55% over the lots. Still looking for that 70% as well as trash needing to be removed in Cul de Sac
Site Visit Failed 4/17/2024 4/17/2024 04/17/2024
Misc
Informational
01/18/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance.
Site Visit Partial 4/23/2024 4/23/2024 04/23/2024
Misc
Informational
04/17/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed.
Site Visit Partial 5/31/2024 5/31/2024 05/31/2024
Misc
Informational
04/23/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established.
Site Visit Partial 6/26/2024 6/26/2024 06/26/2024
Misc
Informational
05/31/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established. 6-26-24 DP. Still waiting on the excess concrete clean out pile to be removed and a proper clean out area to be established.
Site Visit Partial 7/23/2024 7/23/2024 07/23/2024
Misc
Informational
06/26/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established. 6-26-24 DP. Still waiting on the excess concrete clean out pile to be removed and a proper clean out area to be established. 7-23-24 DP. There is an uncontained concrete washout area on the east side of Lumberman's Row about half way down. We need this removed/cleaned up and a contained area established. Once this is done, Lumberman's Row will receive Final Acceptance.
Site Visit Partial 08/14/2024
Misc
Informational
07/23/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established. 6-26-24 DP. Still waiting on the excess concrete clean out pile to be removed and a proper clean out area to be established. 7-23-24 DP. There is an uncontained concrete washout area on the east side of Lumberman's Row about half way down. We need this removed/cleaned up and a contained area established. Once this is done, Lumberman's Row will receive Final Acceptance. 8-8-5 to 8-13 NS Site visited no work is being down.
Erosion Control Inspection Partial 8/22/2024 8/22/2024 08/22/2024
Misc
Informational
03/25/2024
Erosion control measures installed mostly on the pergola park 5th plat areas. 9/6/22 ES Erosion control measures installed on 5 plat areas below this permit are intact and functioning. 9/12/22. ES Erosion control installed, intact and functioning. 9/26/22 ES Erosion control measures installed, intact, and functioning. 10/3/22 ES Erosion control measures installed, intact, and functioning. 10/10/22 ES Erosion control measures installed, intact and functioning. 10/18/22 ES Rain event 10/24, erosion control measures functioning, mostly installed on neighboring plats. 10/25/22 ES Erosion control measures installed, intact, and functioning. 10/31/22 ES Erosion control measures installed, intact, and functioning. Measures held up to rain even from 11/4, had conversation with crews about keeping mud off of existing roads. 11/7/22 ES Erosion control measures installed, intact, and functioning. With snow coming tonight/tomorrow did readdress issues with mud on roadways. 11/14/22 ES Erosion control measures installed, intact, and functioning. 11/21/22 ES 12-12-22 RH. Erosion control is up and in working order. 12-20-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-23 RH. Erosion control is up and in working order. 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 5-2-23 DP. ESC is currently in good working order 6-6-23 DP. ESC is currently in good working order 7-12-23 DP. Talked with Zach from Bair about getting waddles put in storm box throats asap. 7-18-23 DP. ESC is currently in good working order
Miscellaneous Correction
Corrective Action Required
03/25/2024
7-24-23 DP. There are a few erosion breaches from this mornings rain. One is pretty bad and will need to be cleaned up out of the road. They have gutter buddies installed, but need blocks behind them still. Also we need to get silt fence up ASAP since the area is not yet vegetated. 7-28-23 DP. Spoke with Travis with Granite Build yesterday afternoon about Erosion control at Lumberman's row. They hired a company for biweekly checks. They were suppose to report today and clean up any breeches and install new silt fence along Lumberman's Row and Pergola 5th. 8-3-23 DP. Erosion control company came out yesterday and installed silt fence on the west side of lumberman's row, installed blocks behind gutter buddies and did mostly clean up the street which is much appreciated. There is still a good amount of mud and silt on the curbs on the west side and no fence up on the east side. They attempted and did clean up, but it can be better. 8-9-23 DP. Erosion control is still not sufficient along Lumberman's Row. The curb is still full of mud. 8-14-23 DP. ESC has failed. It has still not been addressed and we are having bad erosion problems. Please let me know when ESC company is on site so I can help them notice the problem areas. 8-16-23 DP Erosion Control company just rolled on site. Spoke with Travis on site as well. Seems like they have a great plan in place to get things under control today. I'll check back in throughout the day. 8-17-23 DP. Erosion Control company was on site yesterday and did improve the area a lot. It is still not to standard. I spoke with Travis, who spoke with the company and they will be out this evening or tomorrow to address the subpar areas. 8-18-23 DP. Was notified late this morning by Travis that Erosion control company was on site. I was there with in an hour and they were done with what they did. There is still plenty of ESC measures that need to be addressed. I am failing this ESC inspection again. 8-22-23 DP. Steve and I met onsite with Travis and the Erosion Control company. We agreed on a good plan to get this area in order. 9-19-23 DP. These erosion control issues have been addressed and have been upkept since the previous meeting. 10-3-23 DP. ESC has been and still is in good working order. 10-26-23 DP. Erosion control held up very well for the amount of rain we got. The hill on the west side at the start of Lumberman's is a mudslide. The silt fence will need some attention soon before any future rain events and a couple of strom box throats will need cleaned up. I spoke with Travis today and he said that the AES will be on site early next week, which is reasonable. I know it has been mentioned in the past about hydroseeding that hillside. Lumberman's Row is only lacking vegetation before getting final acceptance. A mix that will grow quickly (K-31) or a method that will help seed grow quickly is highly recommended by me so that we don't have so much erosion coming down the hill. I'm sure whatever seed was thrown in that area is down against the fence now. Thanks. 12-4-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself. 12-20-23 DP. ESC is still in good working order. Still waiting for vegetation to establish itself.
Misc
Informational
03/25/2024
1-2-24 DP. ESC is currently in good working order. Only waiting for the 70% vegetation to establish itself before issuing final acceptance. 3-25-24 DP. ESC is mostly in good working order. There is a small breech on the far north end. Will update after the rain tonight. As for vegetation, it's around 50-55% in the median, still fairly bare. Less than 55% over the lots. Still looking for that 70% as well as trash needing to be removed in Cul de Sac
Misc
Informational
08/22/2024
8-22-24 DP. ESC is still in good working order. Vegetation has been established. Still waiting for the concrete wash out to be cleaned up with a proper clean out area installed. Once this is complete, this area will be in final completion. I have been told that this would be complete multiple times now but with no such luck.
Site Visit Partial 9/4/2024 9/4/2024 09/04/2024
Misc
Informational
08/14/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established. 6-26-24 DP. Still waiting on the excess concrete clean out pile to be removed and a proper clean out area to be established. 7-23-24 DP. There is an uncontained concrete washout area on the east side of Lumberman's Row about half way down. We need this removed/cleaned up and a contained area established. Once this is done, Lumberman's Row will receive Final Acceptance. 8-8-5 to 8-13 NS Site visited no work is being down. 9-4-24 DP. Spoke with Russel and Travis today and both said that the concrete debris will be cleaned up ASAP with a wash out area formed on 6th Plat.
Site Visit Partial 9/17/2024 9/17/2024 09/17/2024
Misc
Informational
09/04/2024
Schlagel onsite staking for water lines and verifying installed structure elevations. 10/18/22 ES 12-27-22 RH. No work being completed on site today. 4-26-23 DP. Crew has been working on installing a 4" drain pipe that runs in front of the storm boxes. 6-12-23 DP. Crew is trying to figure out the best practice to install their 20" curb. 10-17-23 DP. Contractor was doing dirt work and spreading seed along Lumberman's row. 11-17-23 DP. Landscapers are on site today and are currently laying grass seed. The seed that was laid on 10-17 started to come up but very hit and miss/thin. 1-18-24 DP. Waiting on 70% vegetation before issuing final acceptance. 4-17-24 DP. Vegetation has started well. There are a couple small areas of silt that made it through the silt fence and also some trash along the area. If this can be cleaned up soon, we are ready to issue final acceptance. 4-23-24 DP. Silt has been cleaned up and debris has been removed. Still waiting on concrete clean out pile to be removed and a proper clean out to be installed. 5-31-24 DP. Still waiting on concrete clean out pile to be removed and proper clean out area to be established. 6-26-24 DP. Still waiting on the excess concrete clean out pile to be removed and a proper clean out area to be established. 7-23-24 DP. There is an uncontained concrete washout area on the east side of Lumberman's Row about half way down. We need this removed/cleaned up and a contained area established. Once this is done, Lumberman's Row will receive Final Acceptance. 8-8-5 to 8-13 NS Site visited no work is being down. 9-4-24 DP. Spoke with Russel and Travis today and both said that the concrete debris will be cleaned up ASAP with a wash out area formed on 6th Plat. 9-17-24 NS Site visited it appears that no work today.
Documents & Images
Date Uploaded File Type Document Name
08/30/2022 Receipt Receipt for transaction:2022-007141
09/02/2022 Receipt Receipt for transaction:2022-007249
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/07/2022 Approved Plans Lumbermans Row - Sanitary Approved 9.7.22
09/07/2022 Approved Plans Lumbermans Row - Street & Storm Approved 9.7.22
09/07/2022 Approved Plans Lumbermans Row - Mass Grading & ESC Approved 9.7.22
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/08/2022 Letter INSPECTION SUMMARY
09/09/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter DE-Permit
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/07/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/28/2022 Letter INSPECTION SUMMARY
10/28/2022 Letter INSPECTION SUMMARY
10/28/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/29/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
11/01/2022 Letter INSPECTION SUMMARY
11/02/2022 Letter INSPECTION SUMMARY
11/03/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/16/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter INSPECTION SUMMARY
11/21/2022 Letter INSPECTION SUMMARY
11/23/2022 Receipt Receipt for transaction:2022-009121
11/29/2022 Letter INSPECTION SUMMARY
12/01/2022 Letter INSPECTION SUMMARY
12/01/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/06/2022 Letter INSPECTION SUMMARY
12/07/2022 Letter INSPECTION SUMMARY
12/08/2022 Letter INSPECTION SUMMARY
12/09/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Approved Plans Approved Water Plans_121222_Lumberman's Row_22-034-WAT (REV2)
12/20/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/27/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/29/2022 Letter INSPECTION SUMMARY
12/29/2022 Letter INSPECTION SUMMARY
12/29/2022 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/05/2023 Letter INSPECTION SUMMARY
01/06/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY
01/10/2023 Letter INSPECTION SUMMARY
01/11/2023 Letter INSPECTION SUMMARY
01/11/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/02/2023 Letter INSPECTION SUMMARY
02/03/2023 7B83A765-7894-49A9-BCD3-D891326ED64A
02/03/2023 Letter INSPECTION SUMMARY
02/03/2023 24B56D95-0628-4449-99F1-70415078EAA3
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/13/2023 Letter INSPECTION SUMMARY
02/14/2023 Letter INSPECTION SUMMARY
02/15/2023 Letter INSPECTION SUMMARY
02/16/2023 Letter INSPECTION SUMMARY
02/17/2023 Total Coliform 1
02/17/2023 Letter INSPECTION SUMMARY
02/21/2023 Total Coliform 2
02/21/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter INSPECTION SUMMARY
02/22/2023 Letter INSPECTION SUMMARY
02/23/2023 Letter INSPECTION SUMMARY
02/24/2023 Letter INSPECTION SUMMARY
03/17/2023 Letter INSPECTION SUMMARY
03/22/2023 Letter INSPECTION SUMMARY
04/26/2023 Letter INSPECTION SUMMARY
05/02/2023 Letter INSPECTION SUMMARY
05/05/2023 Letter INSPECTION SUMMARY
05/22/2023 Letter INSPECTION SUMMARY
05/17/2023 Plans 22-034-WAT (ASBUILTS)
05/17/2023 Plans 22-034-SAN (ASBUILTS)
05/23/2023 Letter INSPECTION SUMMARY
05/31/2023 Letter INSPECTION SUMMARY
06/06/2023 Letter INSPECTION SUMMARY
06/06/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/07/2023 Letter INSPECTION SUMMARY
06/12/2023 Letter INSPECTION SUMMARY
06/21/2023 Letter INSPECTION SUMMARY
06/23/2023 Letter INSPECTION SUMMARY
06/23/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
07/12/2023 Letter INSPECTION SUMMARY
07/14/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/24/2023 Letter INSPECTION SUMMARY
07/24/2023 Letter INSPECTION SUMMARY
07/28/2023 Letter INSPECTION SUMMARY
06/01/2023 Accepted Record Drawings Lumbermans Row Water AsBuilt Accepted RD
06/01/2023 Accepted Record Drawings Lumbermans Row Sanitary AsBuilt Accepted RD
08/03/2023 Letter INSPECTION SUMMARY
08/09/2023 Letter INSPECTION SUMMARY
08/14/2023 Letter INSPECTION SUMMARY
08/16/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/18/2023 Letter INSPECTION SUMMARY
08/24/2023 Letter INSPECTION SUMMARY
09/07/2023 Plans 22-034 SS (AS-BUILTS)
09/07/2023 Plans 22-034 MDP (AS-BUILTS)
09/08/2023 Accepted MDP Lumbermans Row MDP AsBuilt Accepted
09/08/2023 Accepted Record Drawings Lumbermans Row Street Storm AsBuilt Accepted RD
09/11/2023 Letter Lumbermans Row Substantial Completion
09/11/2023 Letter DE-Certificate of Substantial Completion Single Lot
09/11/2023 Letter DE-Punch List
09/19/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/04/2023 Letter Lumbermans Row Maintenance Bond
10/18/2023 Letter INSPECTION SUMMARY
10/26/2023 Affidavit-Lee's Summit
10/26/2023 Letter INSPECTION SUMMARY
11/17/2023 Letter INSPECTION SUMMARY
12/04/2023 Letter INSPECTION SUMMARY
12/20/2023 Letter INSPECTION SUMMARY
01/02/2024 Letter INSPECTION SUMMARY
01/18/2024 Letter INSPECTION SUMMARY
03/25/2024 Letter INSPECTION SUMMARY
04/17/2024 Letter INSPECTION SUMMARY
04/23/2024 Letter INSPECTION SUMMARY
05/31/2024 Letter INSPECTION SUMMARY
06/26/2024 Letter INSPECTION SUMMARY
06/26/2024 Letter INSPECTION SUMMARY
07/23/2024 Letter INSPECTION SUMMARY
08/14/2024 Letter INSPECTION SUMMARY
08/22/2024 Letter INSPECTION SUMMARY
09/04/2024 Letter INSPECTION SUMMARY
09/17/2024 Letter INSPECTION SUMMARY
11/01/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
