Summary

PRSUBD20201709
Public Infrastructure
Final Acceptance
HUNT MIDWEST REAL ESTATE DEV INC
DEVELOPMENT COMPLETE
Full subdivision development
06/23/2020
09/21/2020
09/15/2023
Locations
Address
2038 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2034 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2030 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2026 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2022 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2018 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2014 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2609 SW HOOK FARM LN, LEES SUMMIT, MO 64082

Address
2023 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2027 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2031 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2035 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2039 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2043 SW FARM FIELD LN, LEES SUMMIT, MO 64082

Address
2046 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2042 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2038 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2034 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2030 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2026 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2022 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2613 SW HOOK FARM LN, LEES SUMMIT, MO 64082

Address
2617 SW HOOK FARM LN, LEES SUMMIT, MO 64082

Address
2621 SW HOOK FARM LN, LEES SUMMIT, MO 64082

Address
2023 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2027 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2031 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2035 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2039 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2043 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2047 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2051 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2103 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2622 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2618 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2614 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2610 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2606 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2602 SW FARM FIELD RD, LEES SUMMIT, MO 64082

Address
2035 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2031 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2027 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2023 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2020 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2024 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2028 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2032 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2036 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2040 SW WHEATFIELD CT, LEES SUMMIT, MO 64082

Address
2003 SW 26TH TER, LEES SUMMIT, MO 64082

Address
2055 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Property
69200070100000000

Property
69200070200000000

Property
69200070300000000

Property
69200070400000000

Property
69200070500000000

Property
69200070600000000

Property
69200060800000000

Property
69200060700000000

Property
69200060600000000

Property
69200060500000000

Property
69200060400000000

Property
69200060300000000

Property
69200060200000000

Property
69200060100000000

Property
69200061300000000

Property
69200061400000000

Property
69200061500000000

Property
69200061100000000

Property
69200071300000000

Property
69200071200000000

Property
69200071100000000

Property
69200061000000000

Property
69200071000000000

Property
69200070900000000

Property
69200070800000000

Property
69200060900000000

Property
69200070700000000

Property
69200061600000000

Property
69200061700000000

Property
69200061800000000

Property
69200061900000000

Property
69200062000000000

Property
69200062200000000

Property
69200050600000000

Property
69200050500000000

Property
69200050400000000

Property
69200050300000000

Property
69200050200000000

Property
69200050100000000

Property
69200040900000000

Property
69200041000000000

Property
69200040800000000

Property
69200041100000000

Property
69200040700000000

Property
69200040200000000

Property
69200040300000000

Property
69200040400000000

Property
69200040600000000

Property
69200040500000000

Property
69200062100000000

Property
69200041200000000

Property
69200061200000000

Address
2002 SW 26TH TER, LEES SUMMIT, MO 64082

Contacts
HUNT MIDWEST REAL ESTATE DEV INC, Address:8300 UNDERGROUND DR STE 200
OLSSON ASSOCIATES, Address:1301 BURLINGTON, SUITE 100, Phone:(816) 361-1171
HUNT MIDWEST REAL EST DEV INC, Address:8300 NE UNDERGROUND DR
Terry Owens, Address:Hunt Midwest Real Estate Development, Inc, Phone:(816) 455-2500 Ext:116
HUNT MIDWEST RESIDENTIAL LLC, Address:8300 NE UNDERGROUND DR STE 100
EZHAPILLY CHENNEN PRATHEESH PEETHAMBARAN & VISWANATHAN NEENA, Address:2035 SW WHEATFIELD CT
STEVENS SAMUEL ROGER & DIANNE LYNN, Address:2031 SW WHEATFIELD CT
PIXLEY TARA & MARK, Address:2027 SW WHEATFIELD CT
BALLARD CHRISTOPHER G & CARRIE E, Address:2023 SW WHEATFIELD CT
CHEVALIER DYLAN ROBERT & DEEANNA KATHLEEN, Address:2020 SW WHEATFIELD CT
NALLI REBECCA J & DARELL, Address:2024 SW WHEATFIELD CT
MENCHACA BROOKE MARIE, Address:2028 SW WHEATFIELD CT
HUBBARD JUSTIN & LAUREN, Address:2032 SW WHEATFIELD CT
WILSON KATHRINE A AND BRET A, Address:2036 SW WHEATFIELD CT
BANK 21, Address:3301 MO-7
MARZOLF MATTHEW GEORGE & WISDOM CRISTINA MARIA, Address:2602 SW FARM FIELD RD
CEDILLO MONTE B & KELLY C, Address:2610 SW FARM FIELD RD
MANN THOMAS F, Address:2614 SW FARMFIELD LN
RAINEY JORDAN, Address:2014 SW FARM FIELD LN
RIZO JOSE L & VALENTINA L, Address:2018 SW FARM FIELD LN
KATZFEY JACOB & KALI, Address:2022 SW FARM FIELD LN
LOEHR COLE & MADISON, Address:2031 SW FARM FIELD LN
TAYLOR STEPHEN & KARISSA E, Address:2030 SW FARM FIELD LN
WEBBER NICHOLAS M, Address:2034 SW FARM FIELD LN
AHMED S MULLA REVOCABLE DECLARATION OF TRUST AGREEMENT DATED 08/30/2012, Address:12120 STATE LINE RD
STEGALL CHRISTOPHER P & LYNN M, Address:2023 SW FARM FIELD LN
COOPER CHLOE, Address:2027 SW FARM FIELD LN
GOFF NICHOLAS & KELSEY, Address:2031 SW FARM FIELD LN
CUMMINGS JOE P & LAUREN M, Address:2035 SW FARM FIELD LN
EDWARDS ALEXANDER & MELISSA, Address:2039 SW FARM FIELD LN
DUSSELLER JACOB, Address:2043 SW FARM FIELD LN
BYLER BENJAMIN T & HALEY N, Address:2022 SW HOOK FARM DR
HENDRICKSON DEBORAH S, Address:2026 SW HOOK FARM DR
JANOTA CHRISTIAN, Address:2030 SW HOOK FARM DR
MALLINSON JOHN & LINDSEY, Address:2034 SW HOOK FARM DR
ROYAL HEATH & ASHLEY, Address:2308 SW HOOK FARM DR
NIEMEYER SCOTT & JENNIFER, Address:2042 SW HOOK FARM DR
PIERZYNSKI MACKENZIE, Address:2046 SW HOOK FARM DR
WILKES RYAN & ANGELA M, Address:2023 SW HOOK FARM DR
PARK WONSIN, Address:2027 SW HOOK FARM DR
JOHN D HOLM & MELINDA M HOLM QUALIFIED SPOUSAL TRUST DATED 07-20-21, Address:2031 SW HOOK FARM DR
FLETCHER FAMILY TRUST DATED 7-25-2022, Address:2035 SW HOOK FARM DR
JONES DARRELL E & TAMMY K, Address:2039 SW HOOK FARM DR
GAYLORD JEFFREY WAYNE & KRISTINA RAE, Address:2043 SW HOOK FARM DR
LEIGH DONALD & MARY, Address:2047 SW HOOK FARM DR
SIMCOX NICHOLAS & JOHNS KATHRYN, Address:2051 SW HOOK FARM DR
HALL JEAN C, Address:2103 SW HOOK FARM DR
BERRY CHRISTOPHER, Address:2609 SW HOOK FARM LN
ALHABASHI MANAL, Address:2613 SW HOOK FARM LN
AMMONS SIDNEY M JR & TINA B, Address:2617 SW HOOK FARM LN
DINH DAN, Address:2621 SW HOOK LN
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/23/2020 09/21/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C9-Water Insp Fee $7,416.17 $7,416.17 Paid 09/10/2020
9110072-Water Test Fee $800.00 $800.00 Paid 09/10/2020
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 09/10/2020
91100C8-Sanitary Sewer Insp Fees $10,726.54 $10,726.54 Paid 09/10/2020
9110068-Storm Fee $6,747.99 $6,747.99 Paid 09/10/2020
9110081-Paved Surface Inspection Fee $9,724.62 $9,724.62 Paid 09/10/2020
9110071-Site Grading Fee $3,853.49 $3,853.49 Paid 09/10/2020
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

Erosion Control Inspection Failed 10/13/2020
Misc
Corrective Action Required
10/13/2020

John DiMauro 10/13/2020 12:22 PM The erosion control devices are not completely installed at this time according to the approved plans. The temporary swale does not appear to be graded properly on the SW end of the site that connects the Sediment basin to the site. The 30” HDPE culvert, trash rack, skimmer and sediment clean out are not installed at this time. Finish constructing the ESC devices per the approved plans prior to construction of the site development infrastructure.
Erosion Control Inspection Passed 10/22/2020
Misc
Corrective Action Required
10/13/2020
John DiMauro 10/13/2020 12:22 PM The erosion control devices are not completely installed at this time according to the approved plans. The temporary swale does not appear to be graded properly on the SW end of the site that connects the Sediment basin to the site. The 30” HDPE culvert, trash rack, skimmer and sediment clean out are not installed at this time. Finish constructing the ESC devices per the approved plans prior to construction of the site development infrastructure.
Misc
Informational
10/22/2020
John DiMauro 10/22/2020 10:03 AM The erosion control devices are installed according to the approved Site Disturbance Stage A plans. Construction of the public infrastructure can begin. Photos are uploaded.

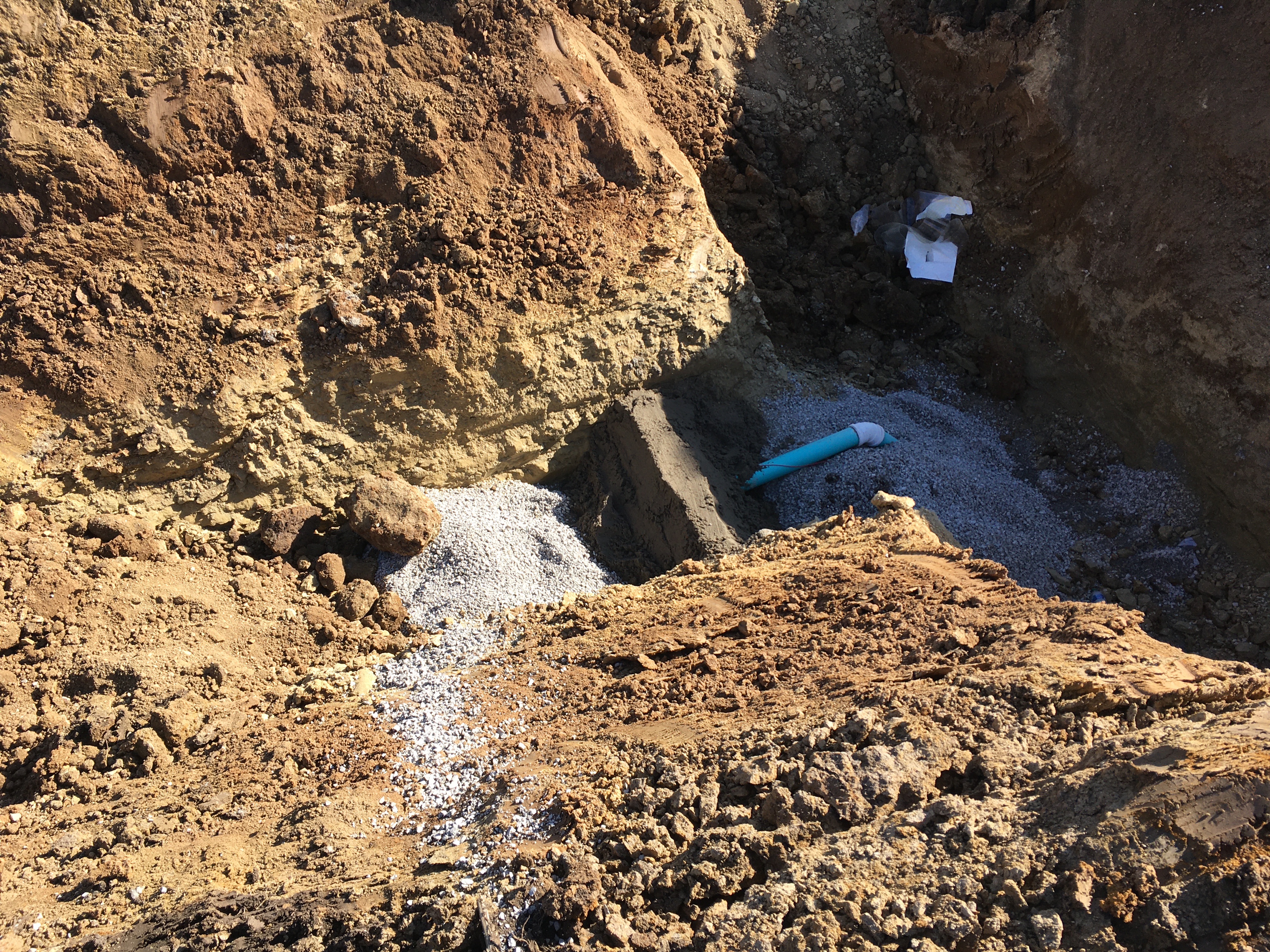

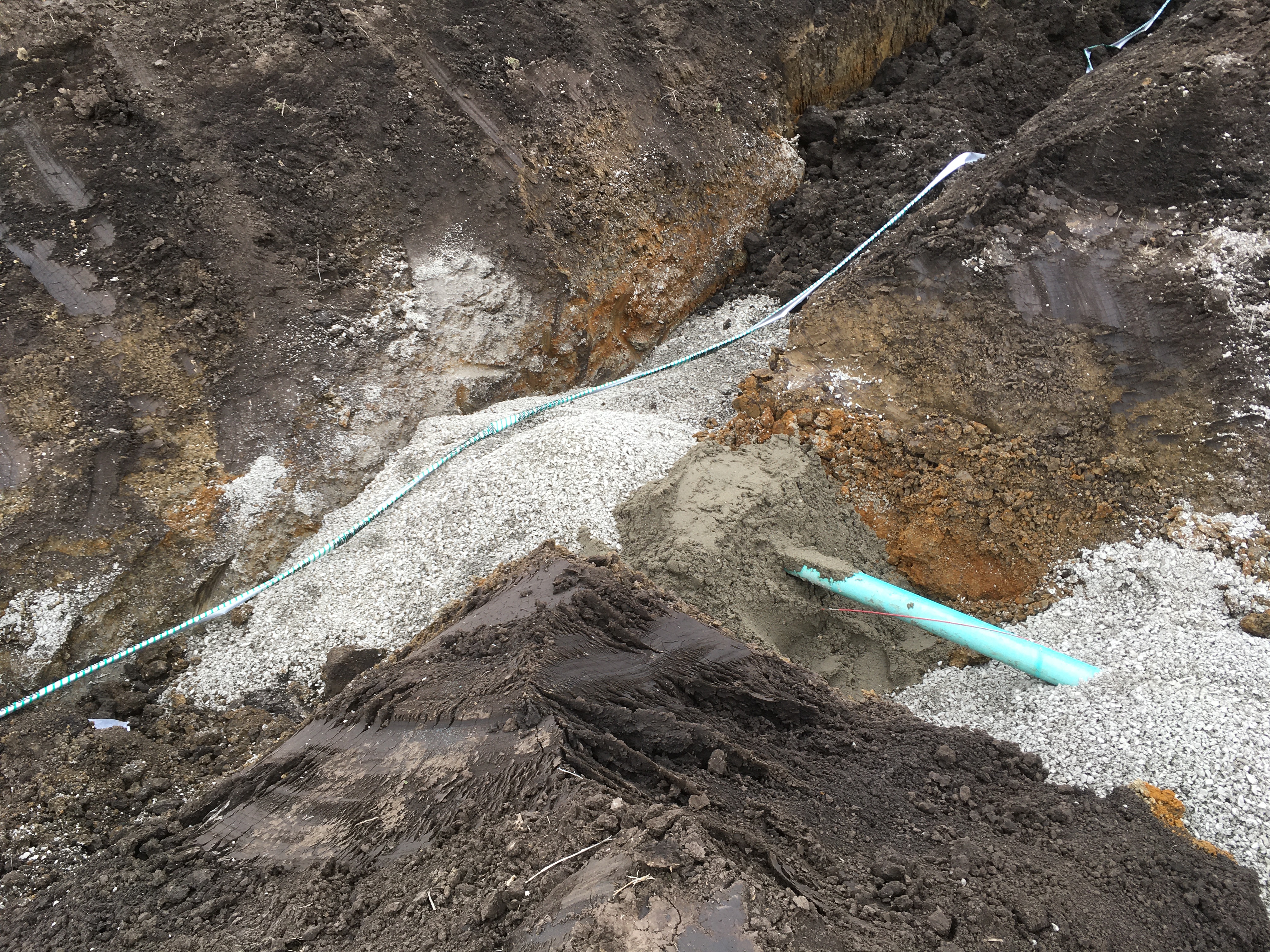

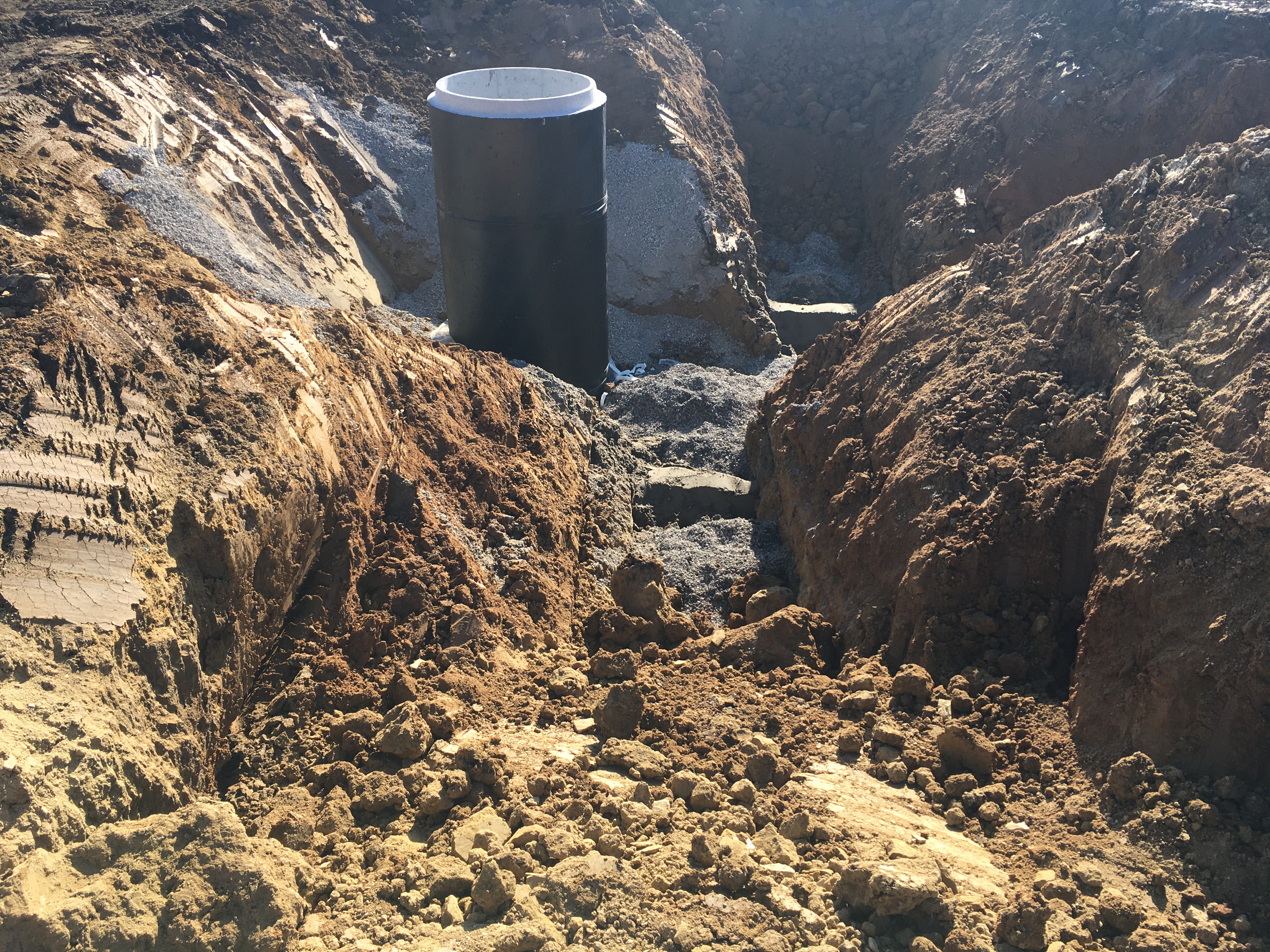

Sanitary Sewer Construction Inspection Partial 11/19/2020
Misc
Informational
11/19/2020

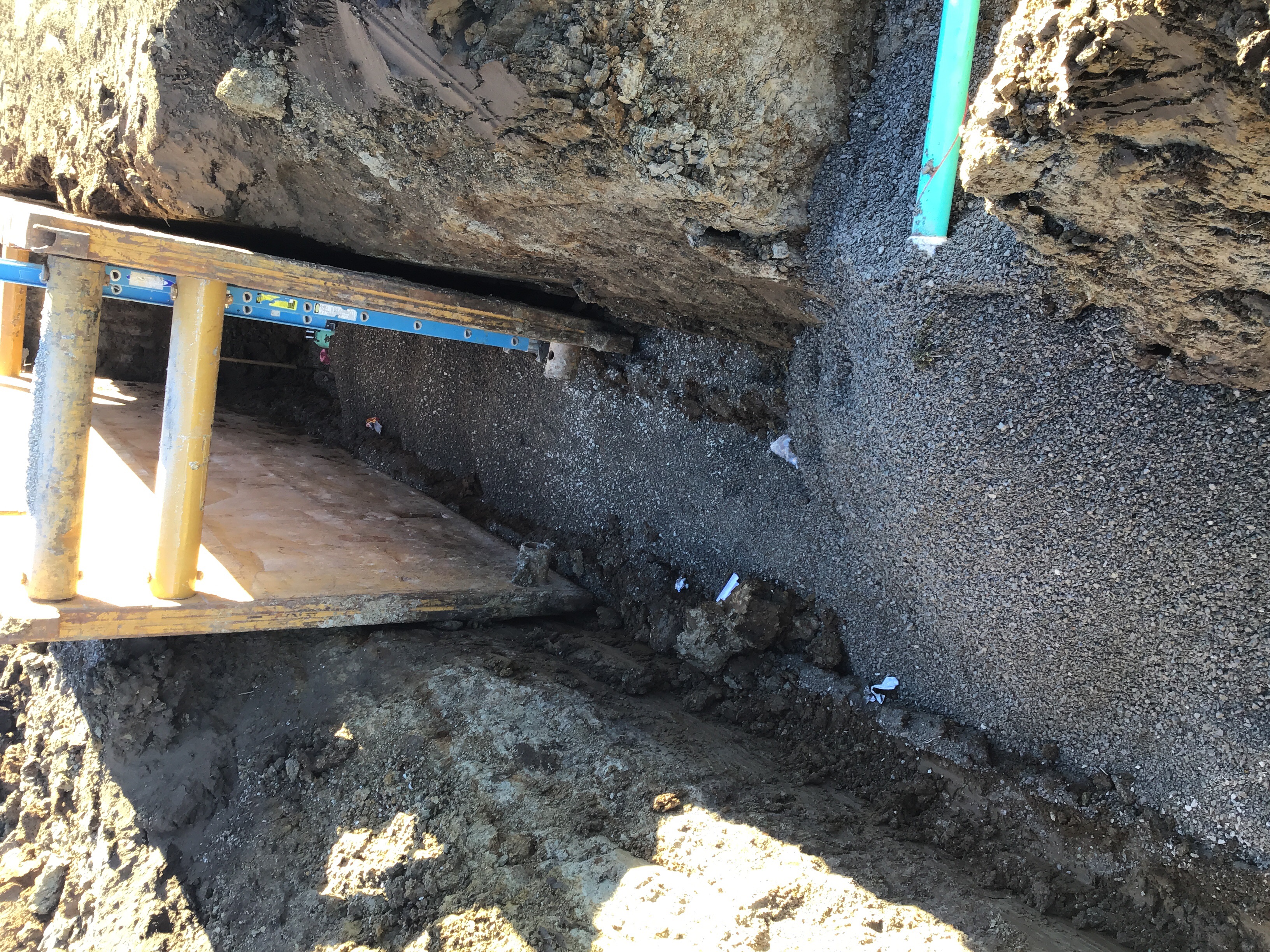

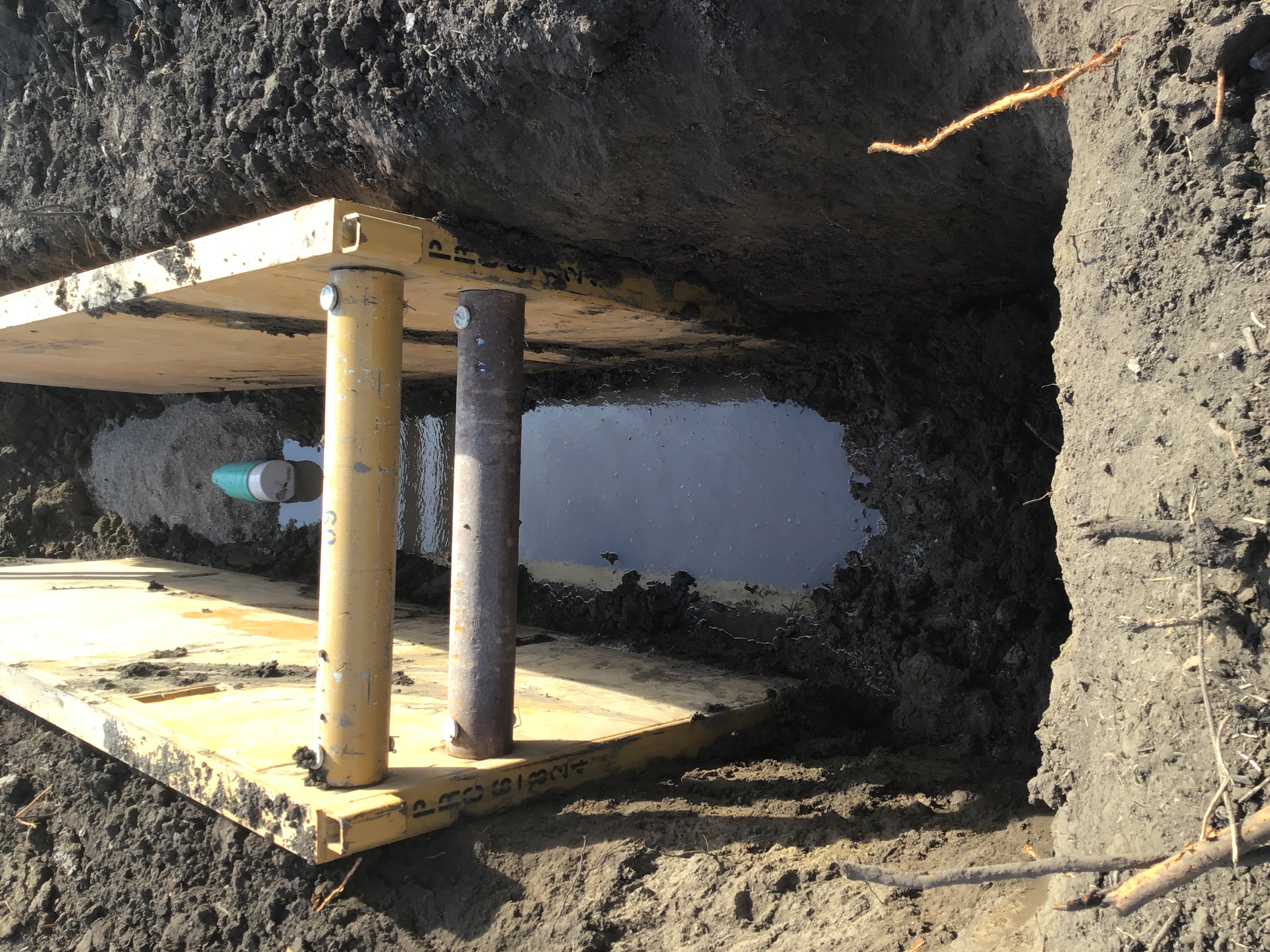

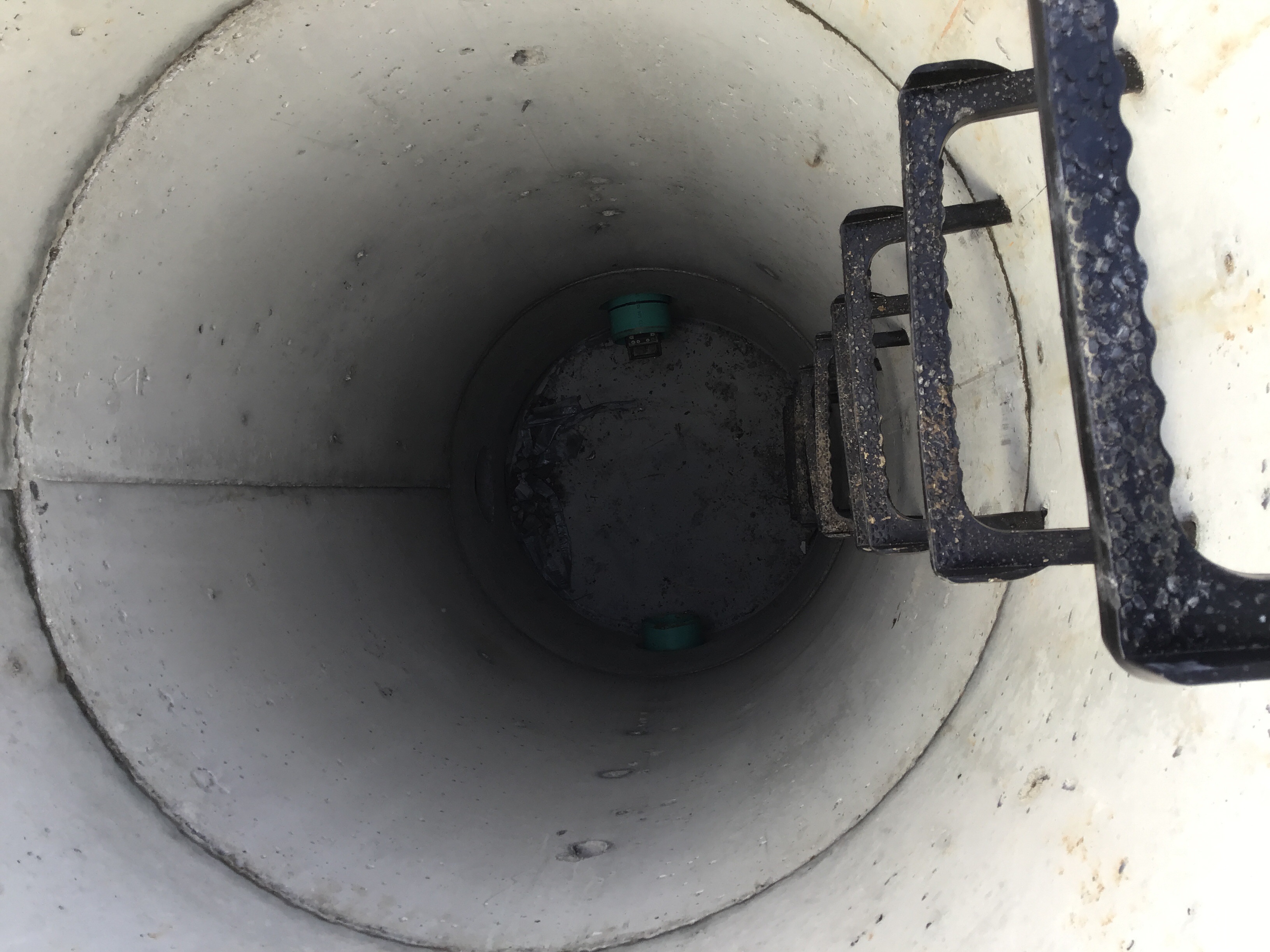

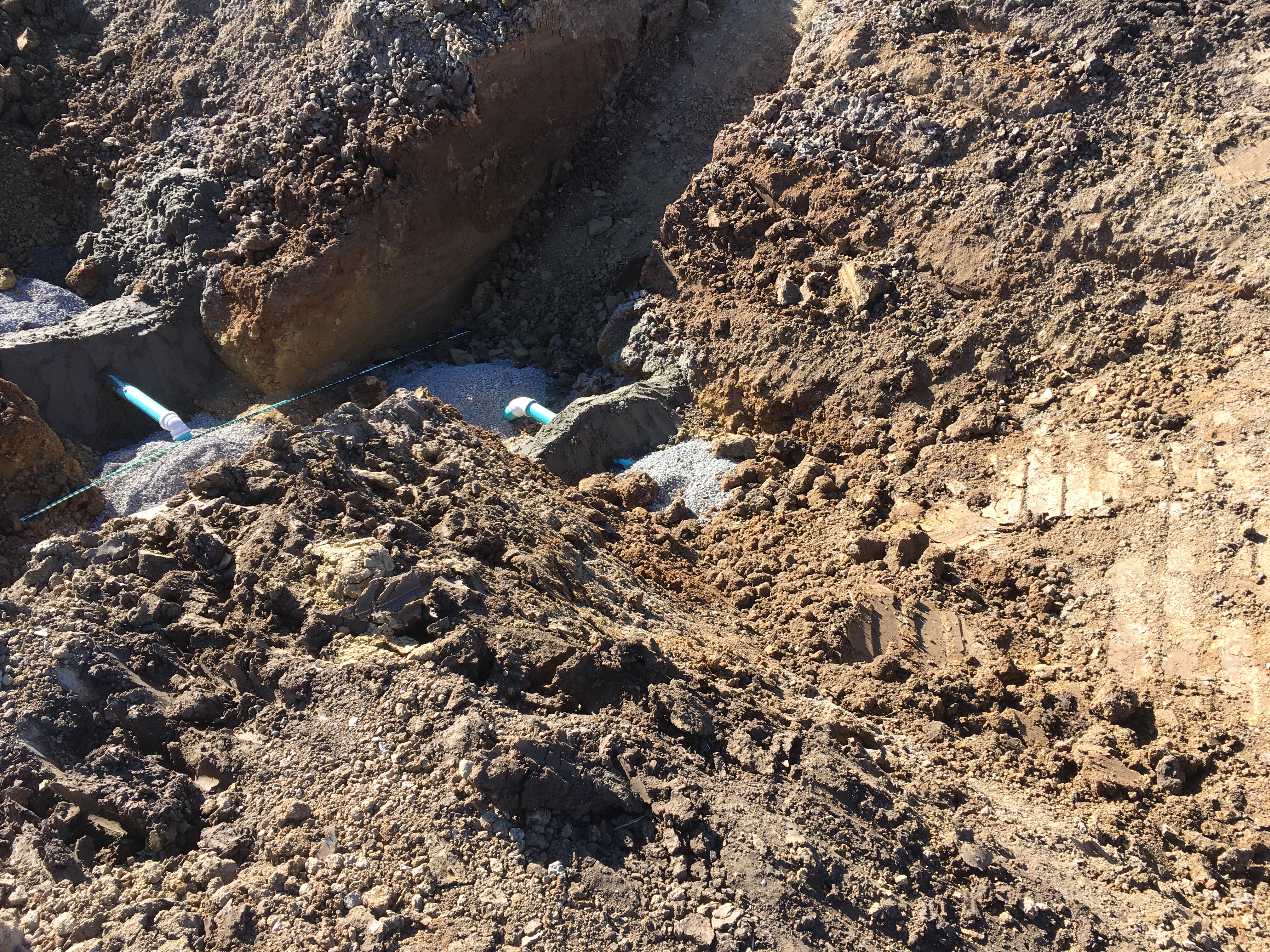

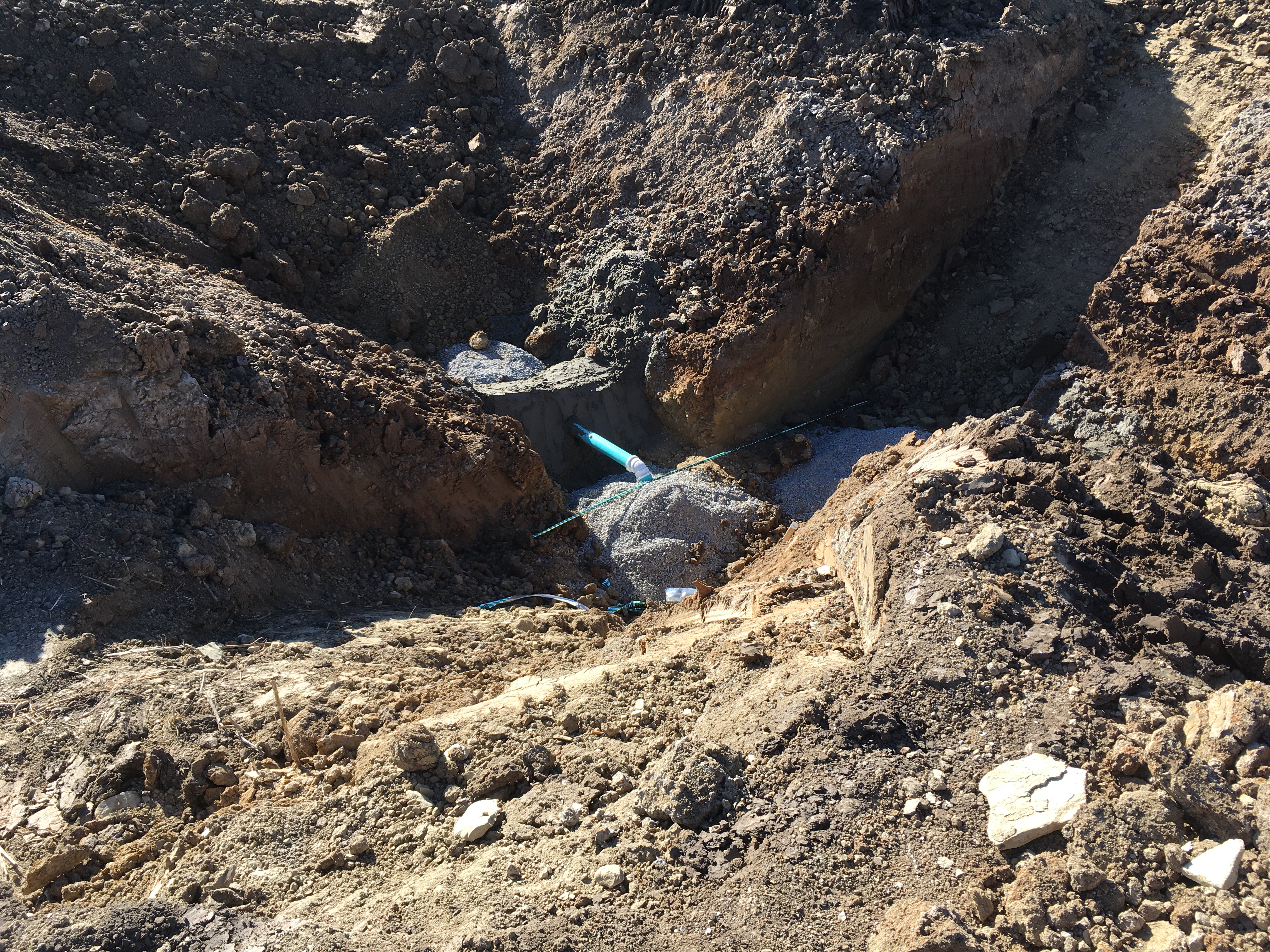

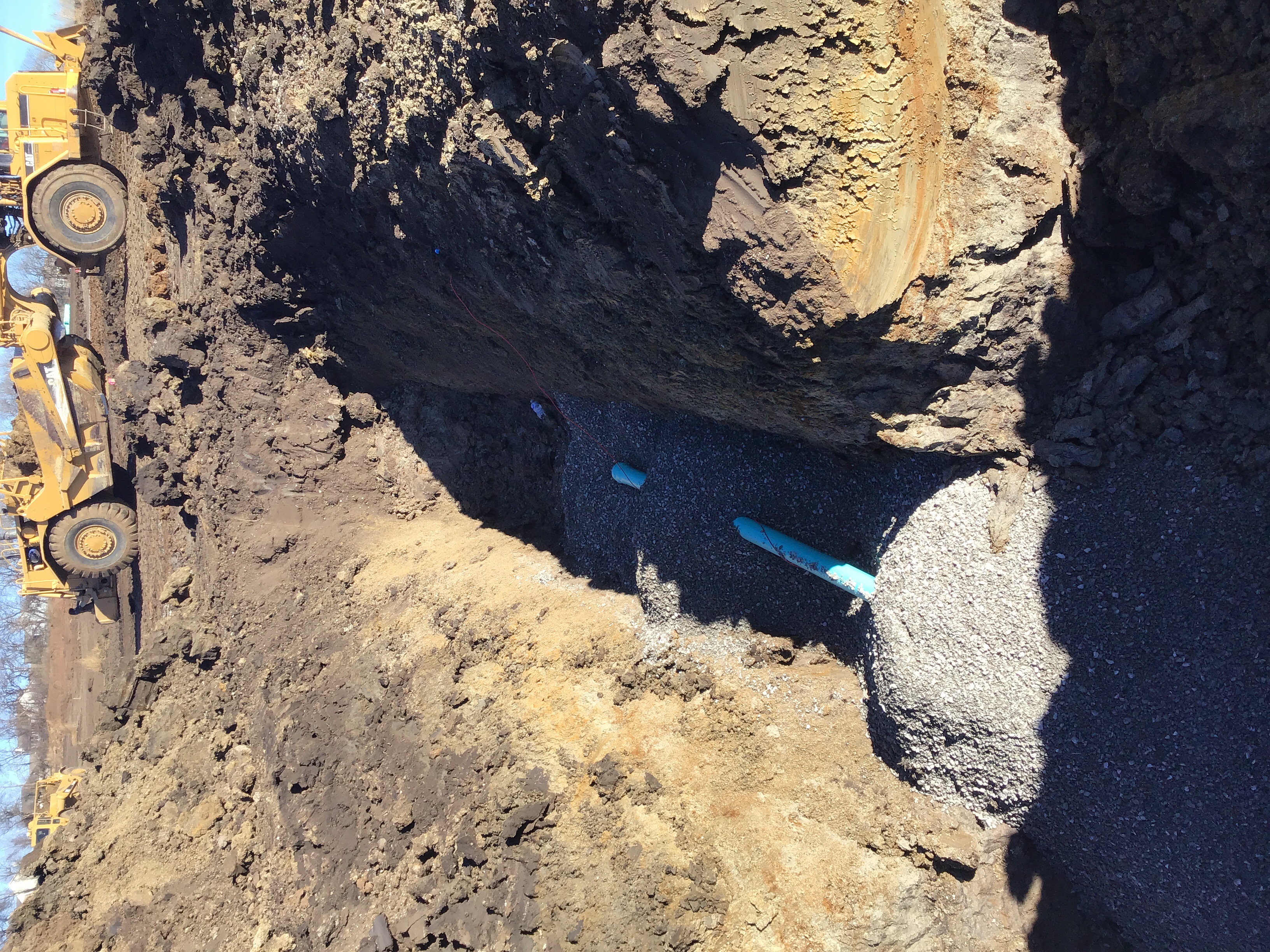

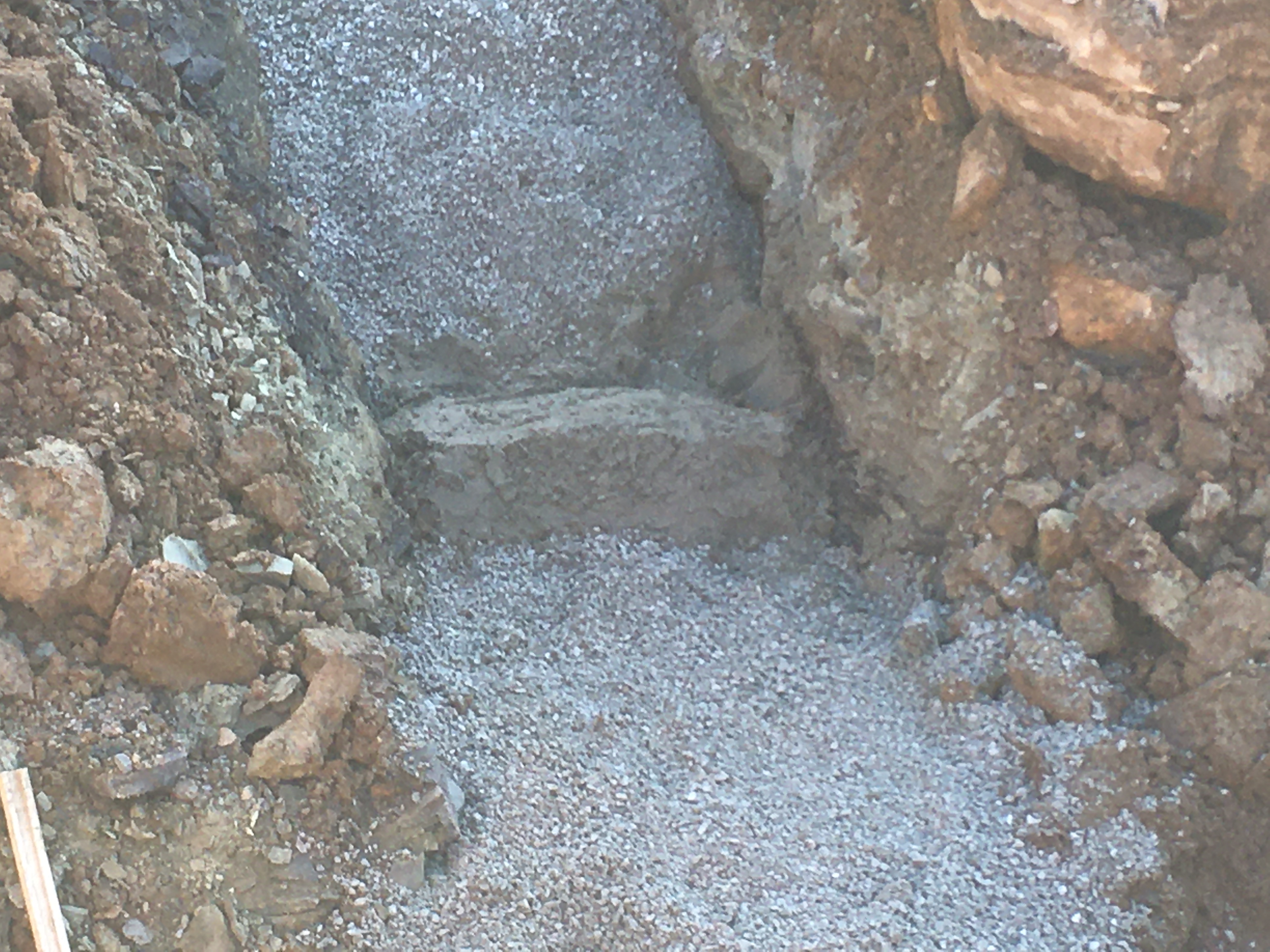

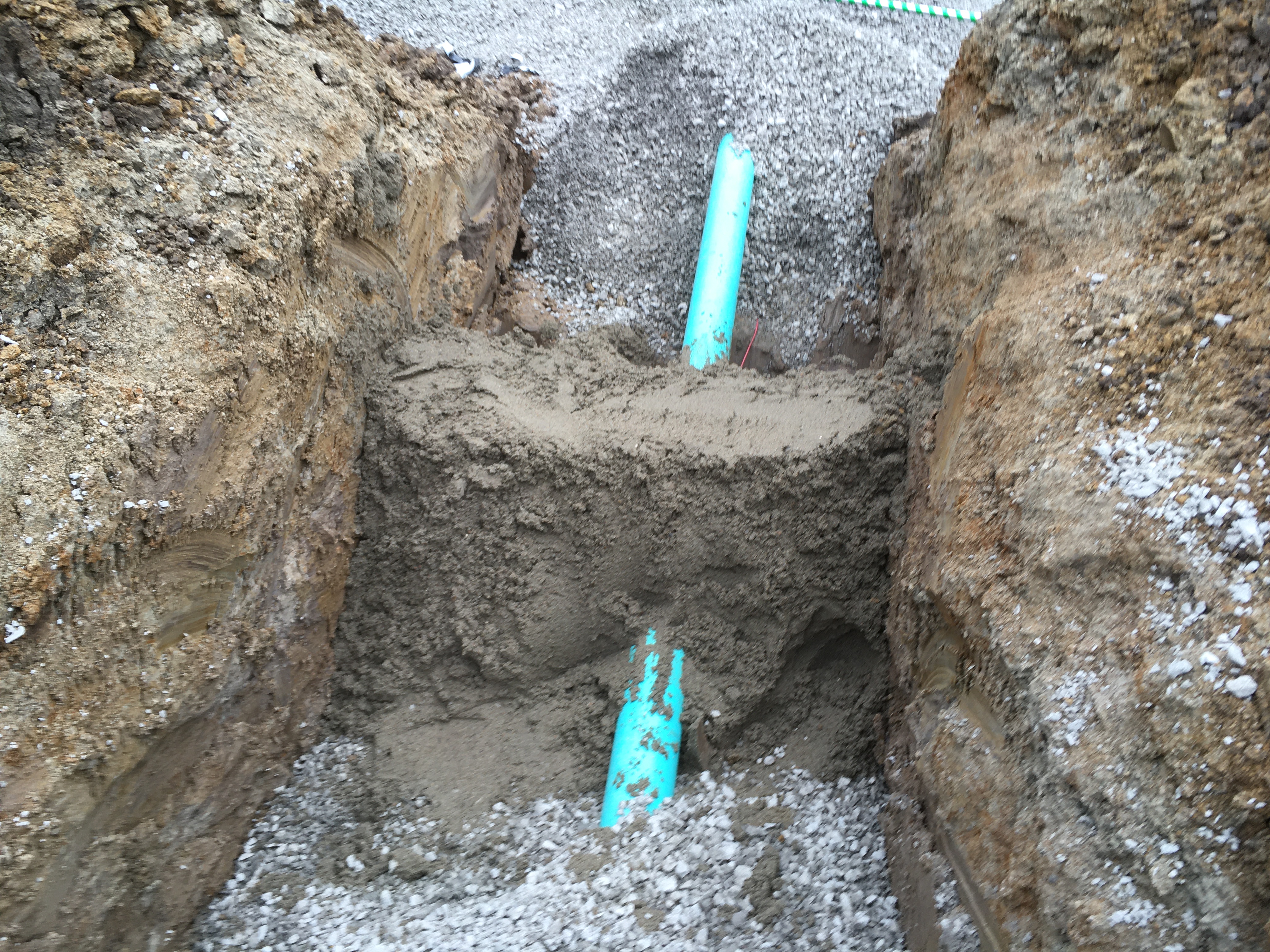

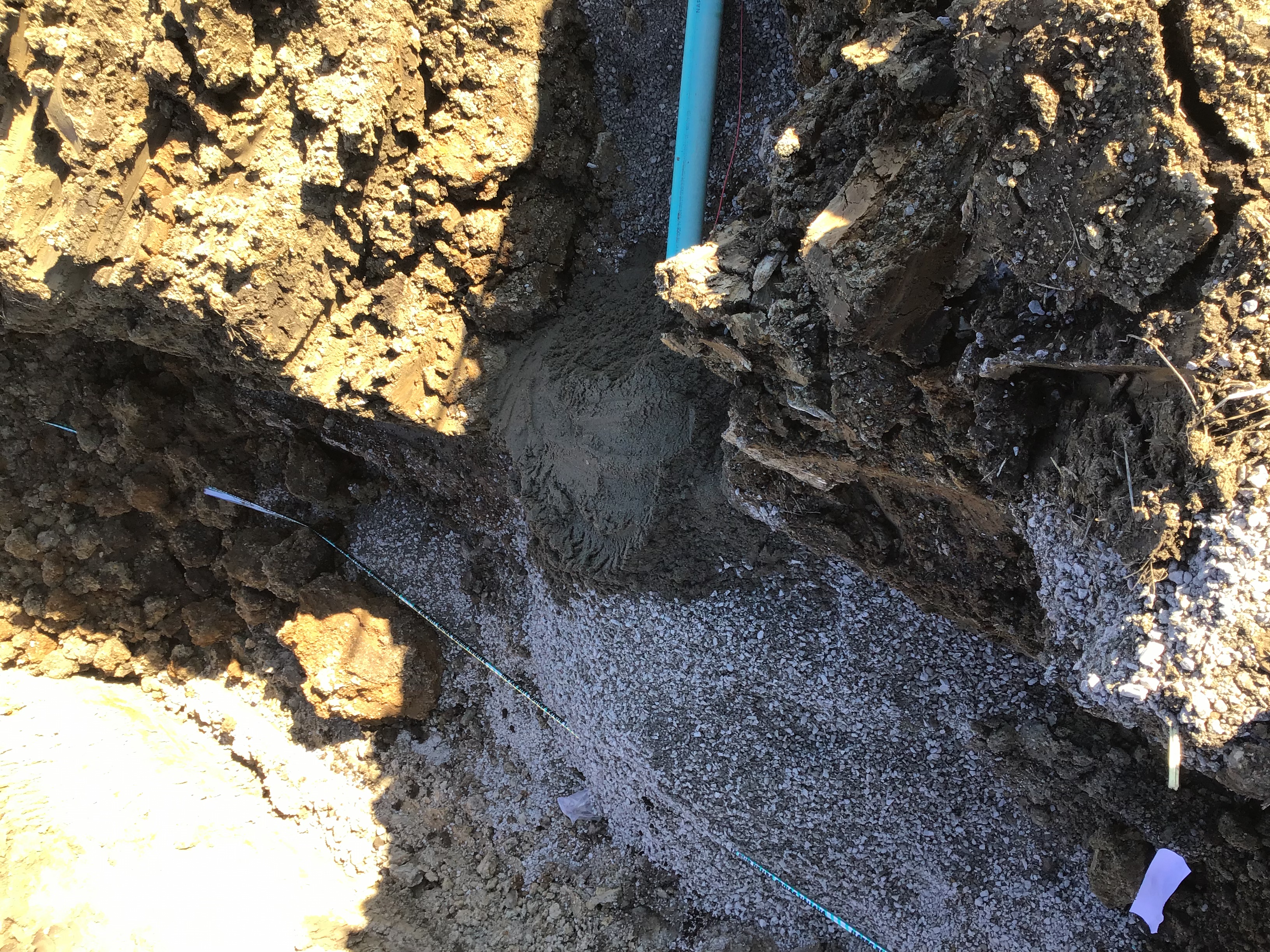

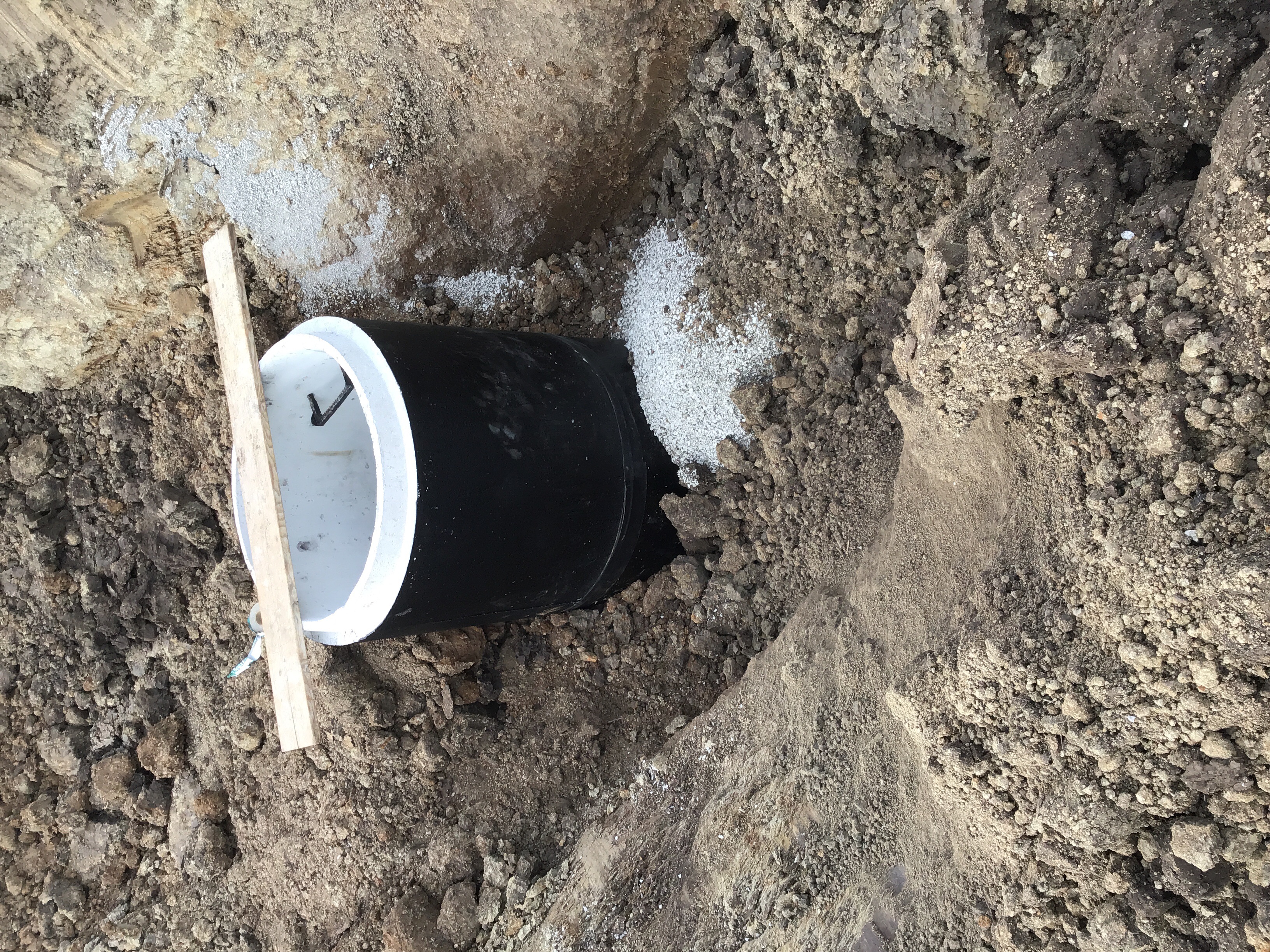

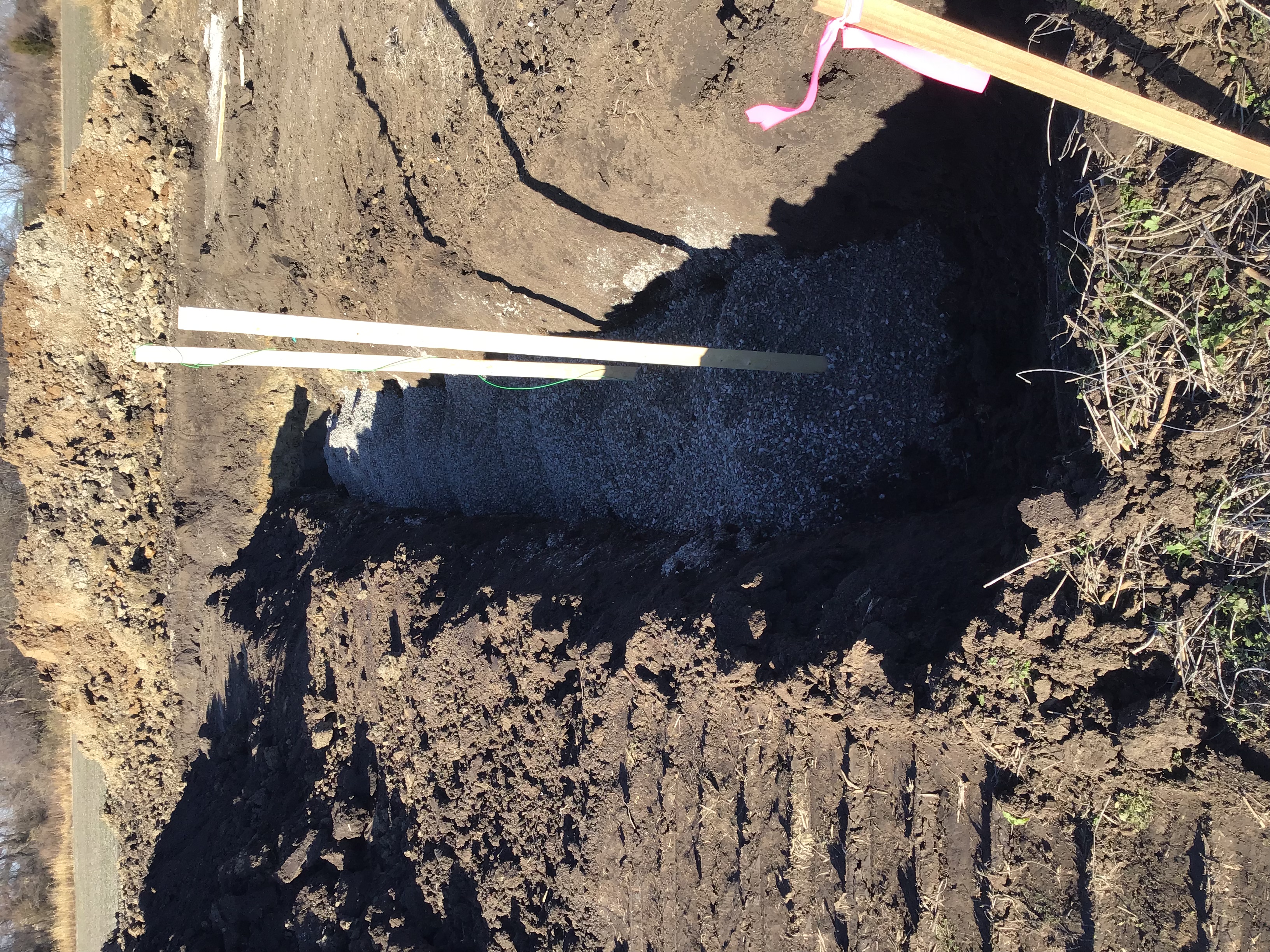

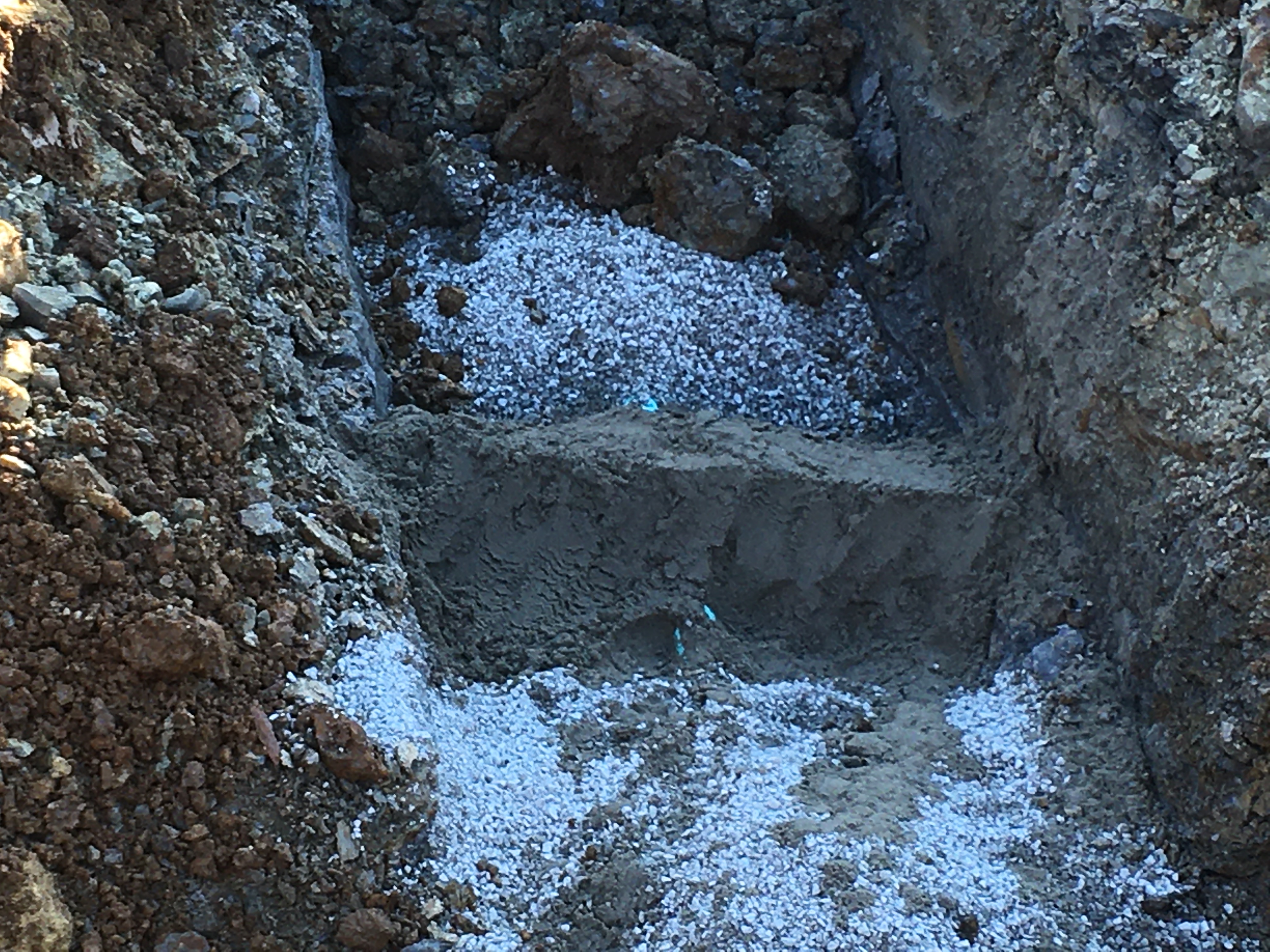

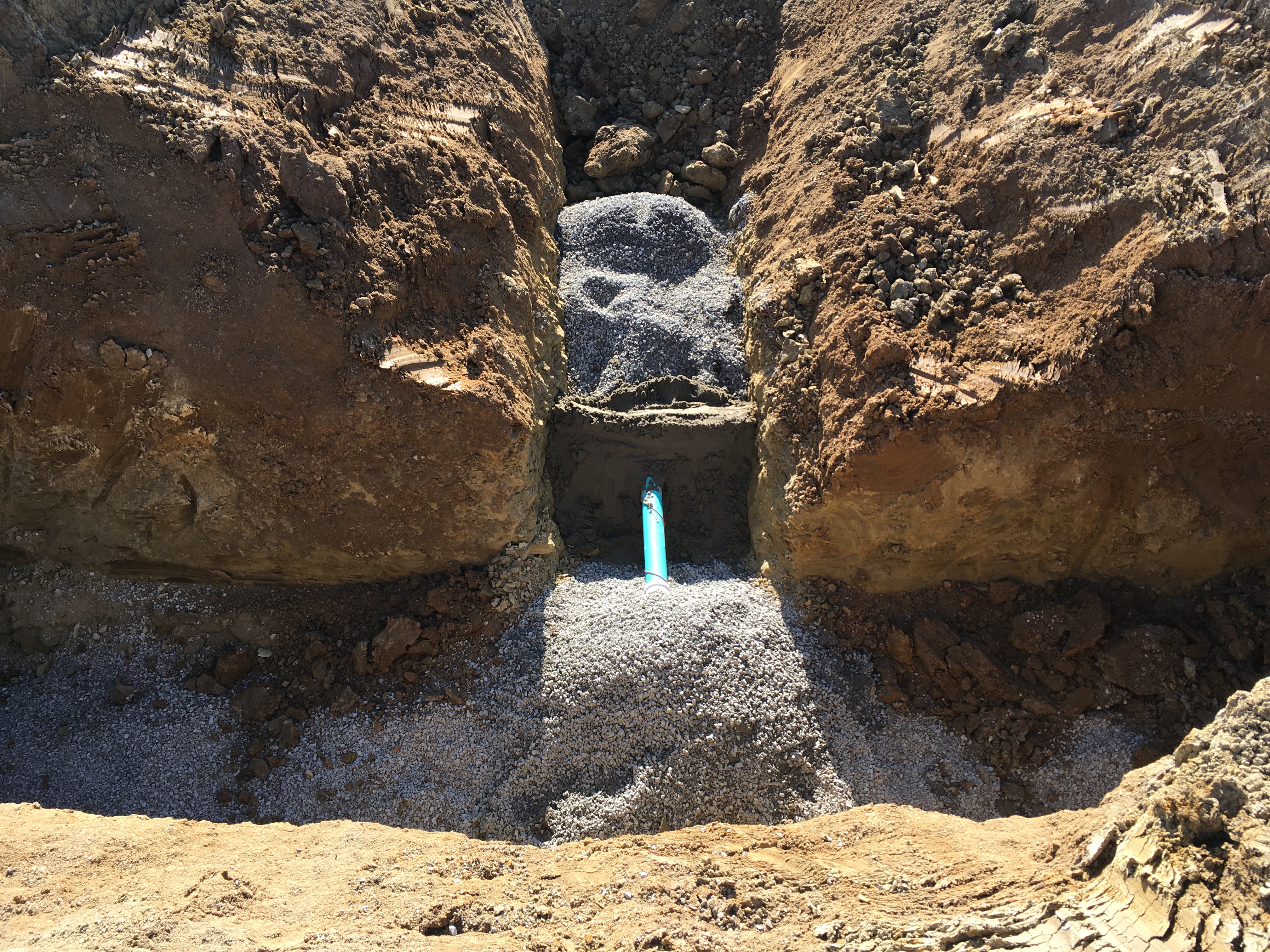

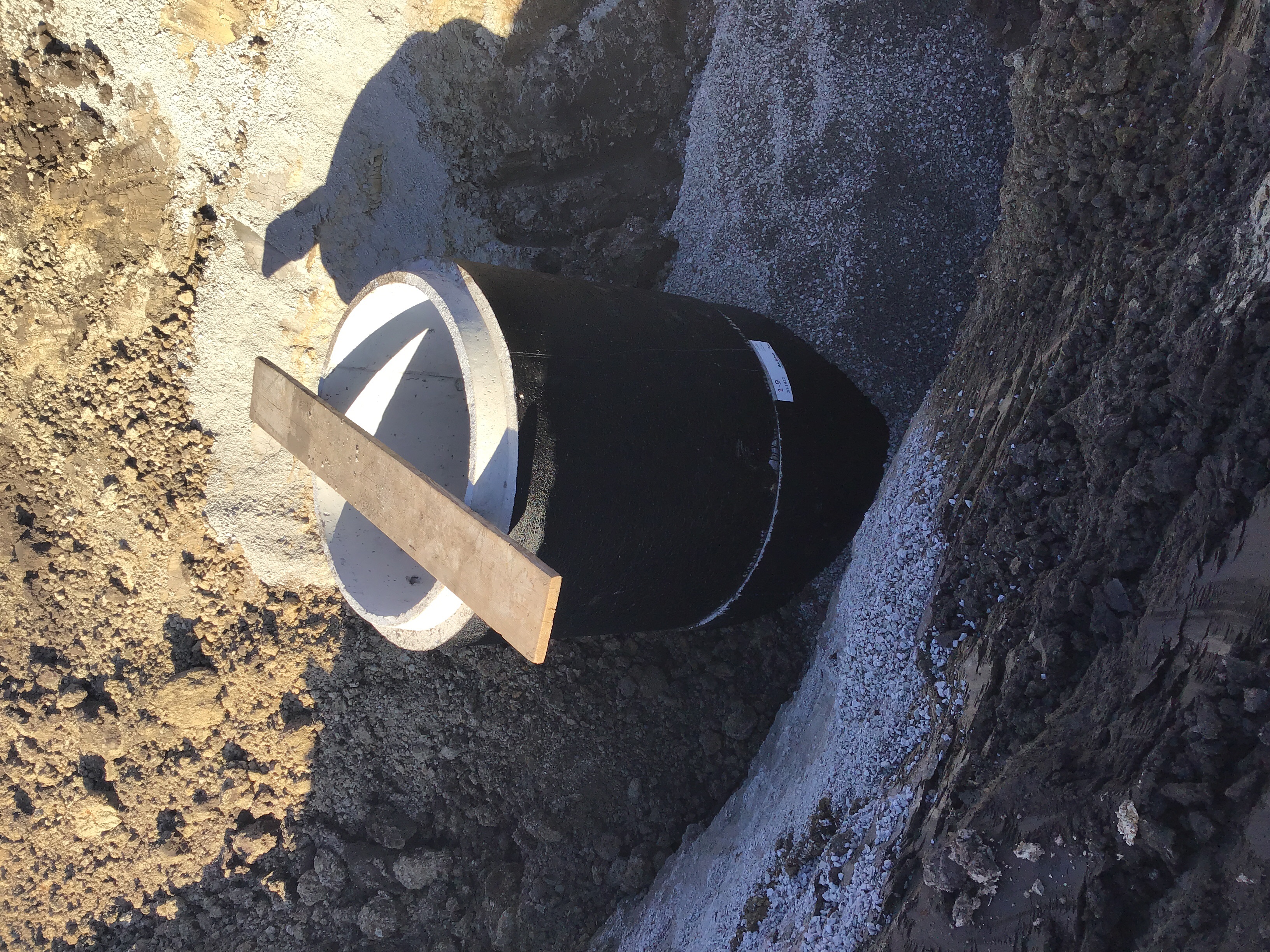

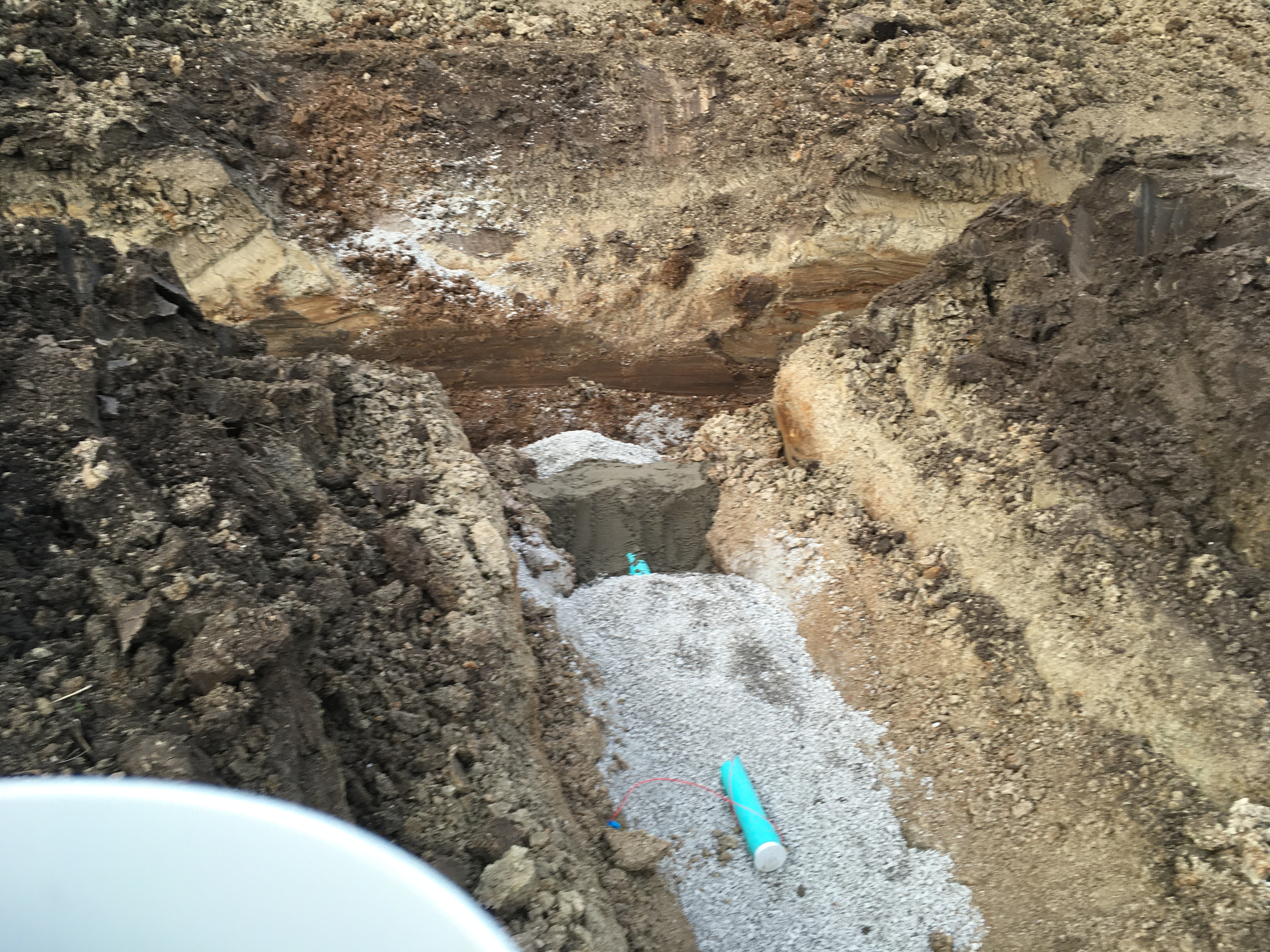

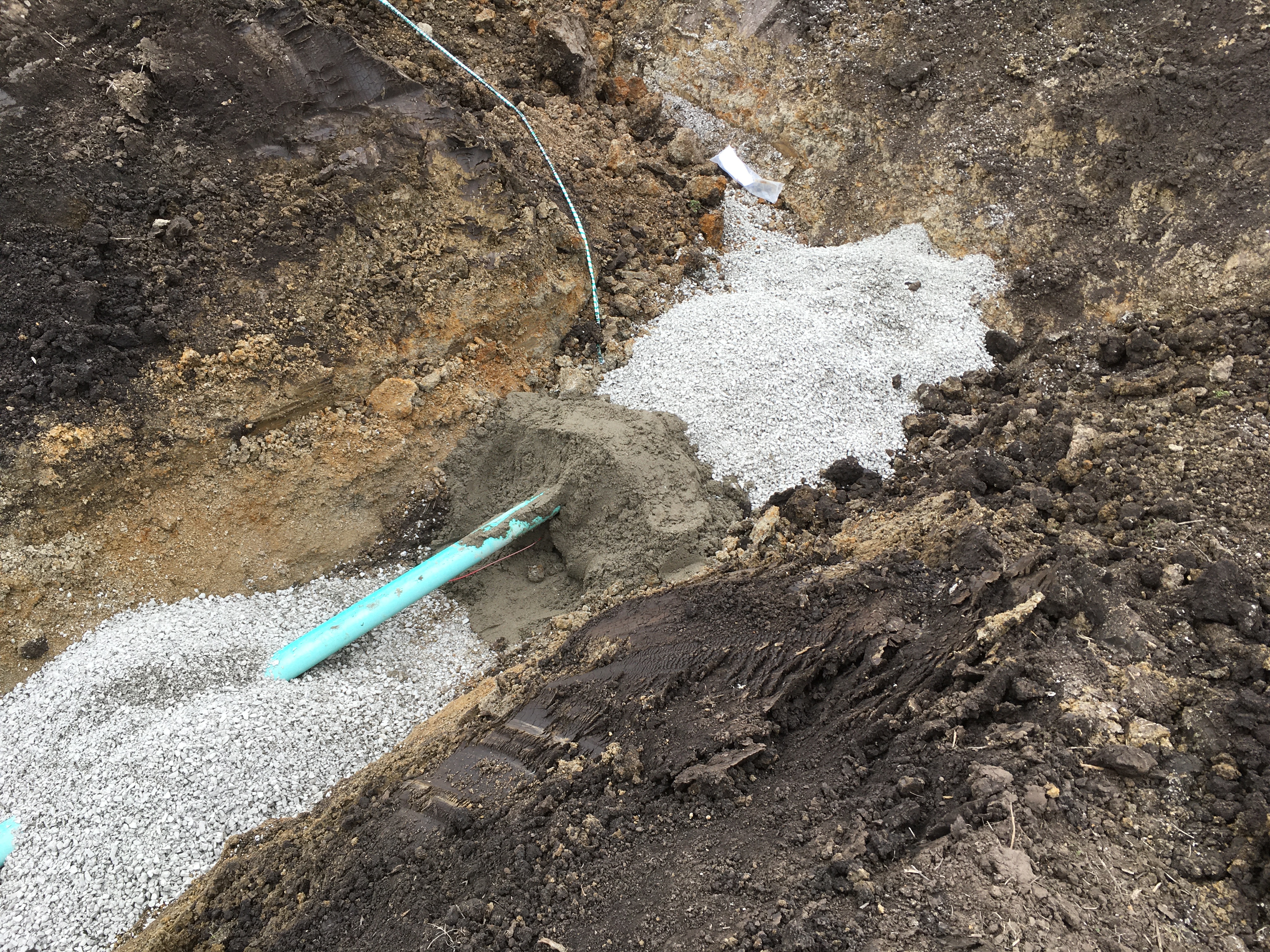

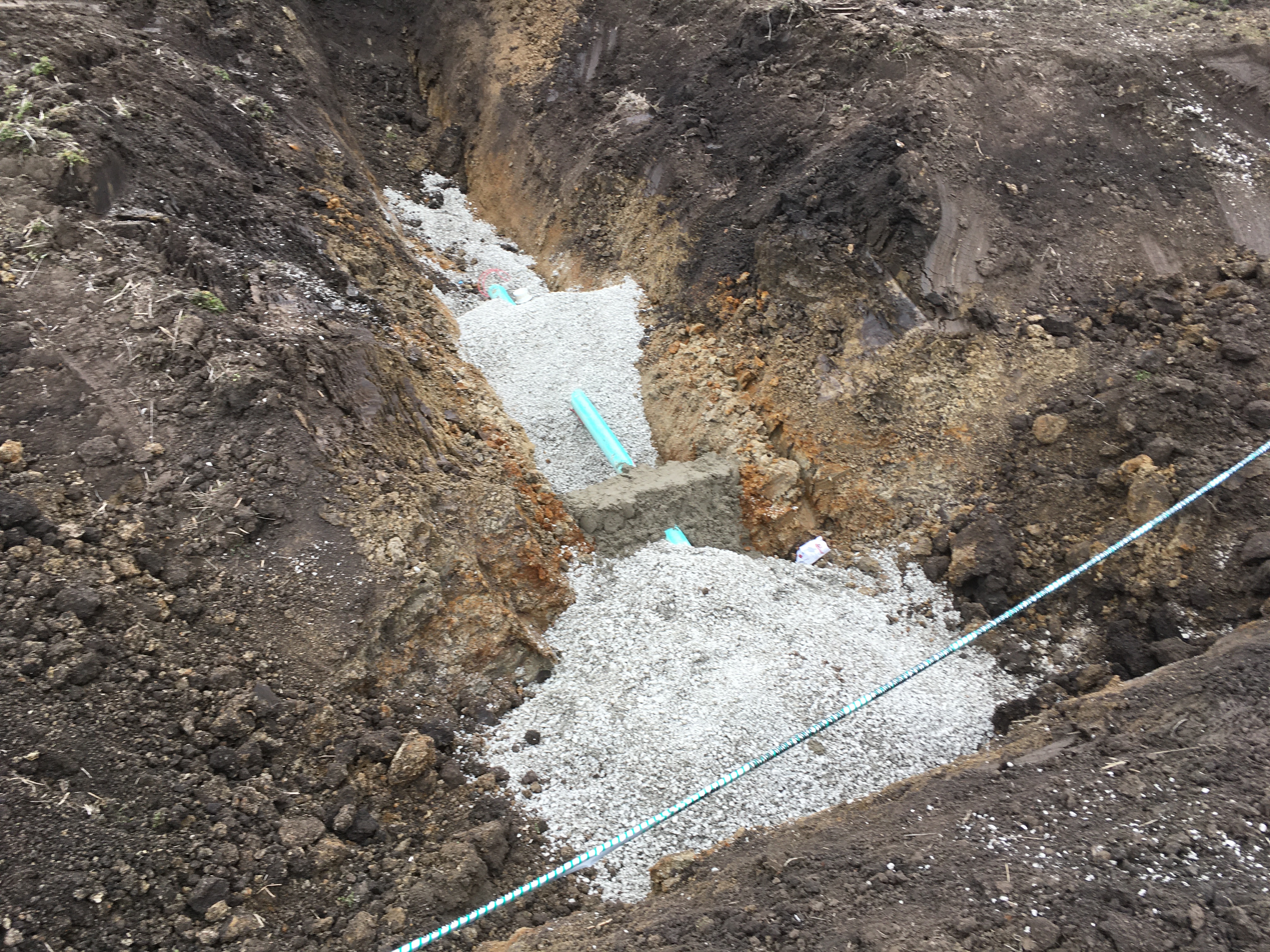

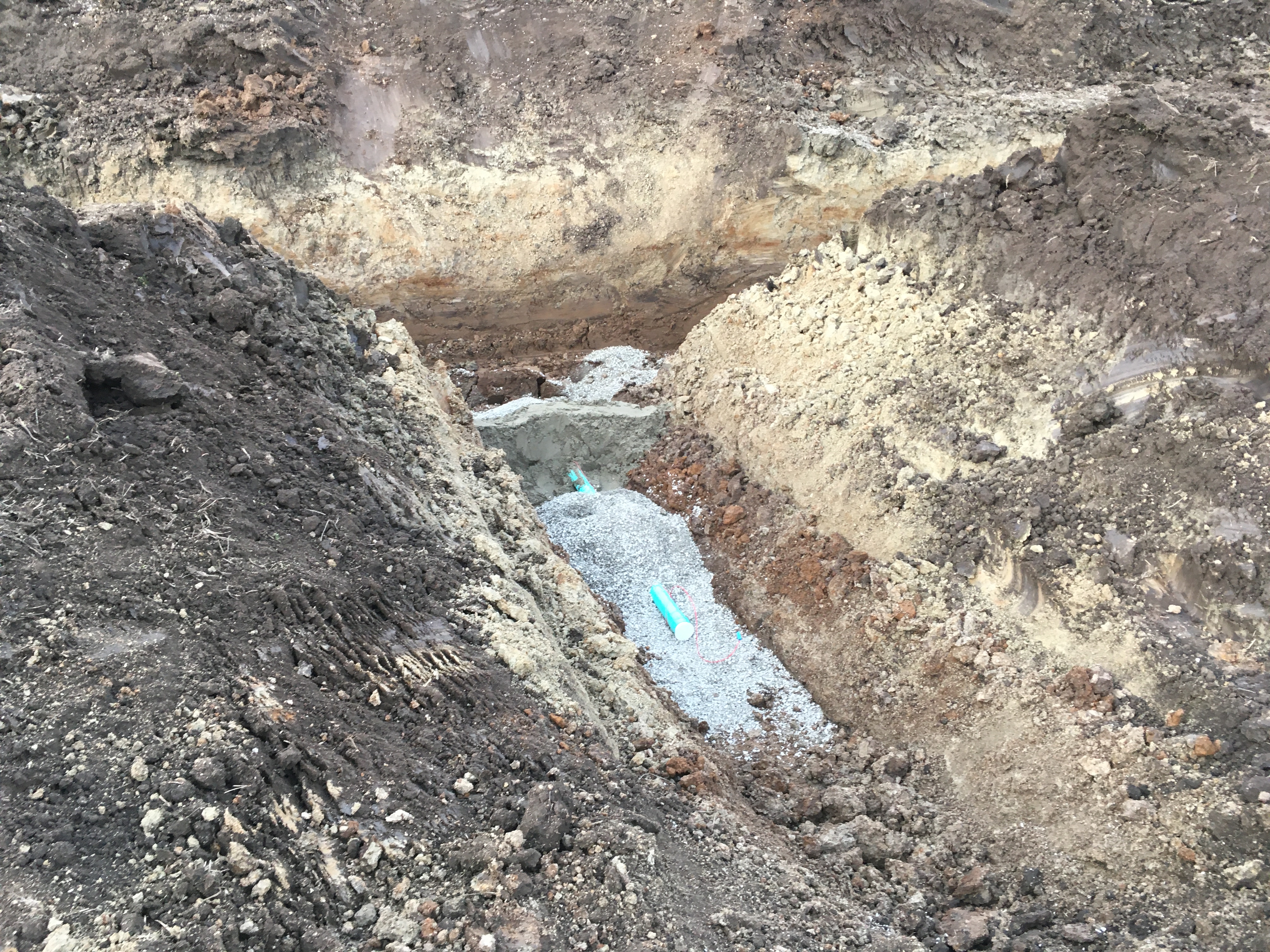

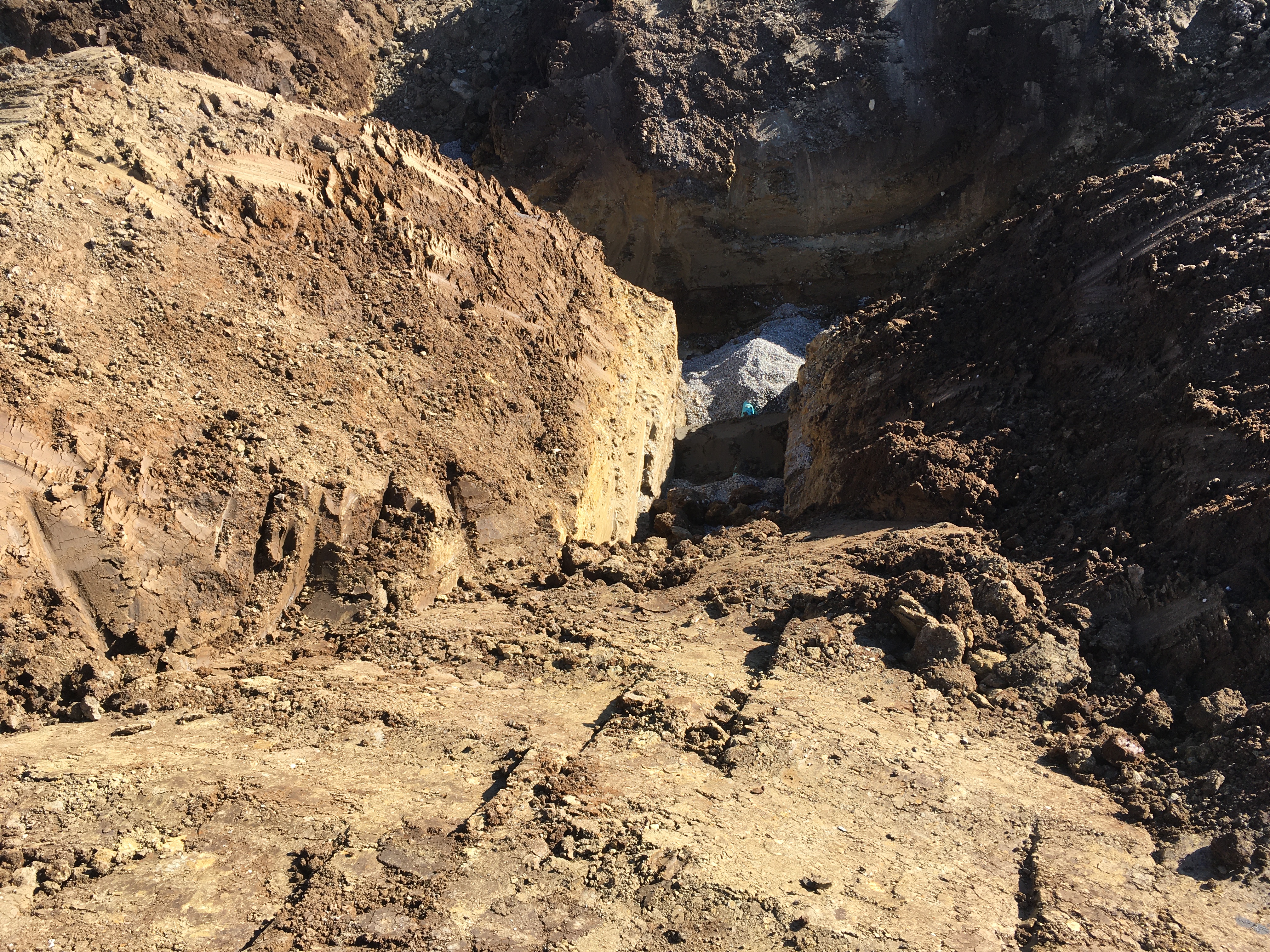

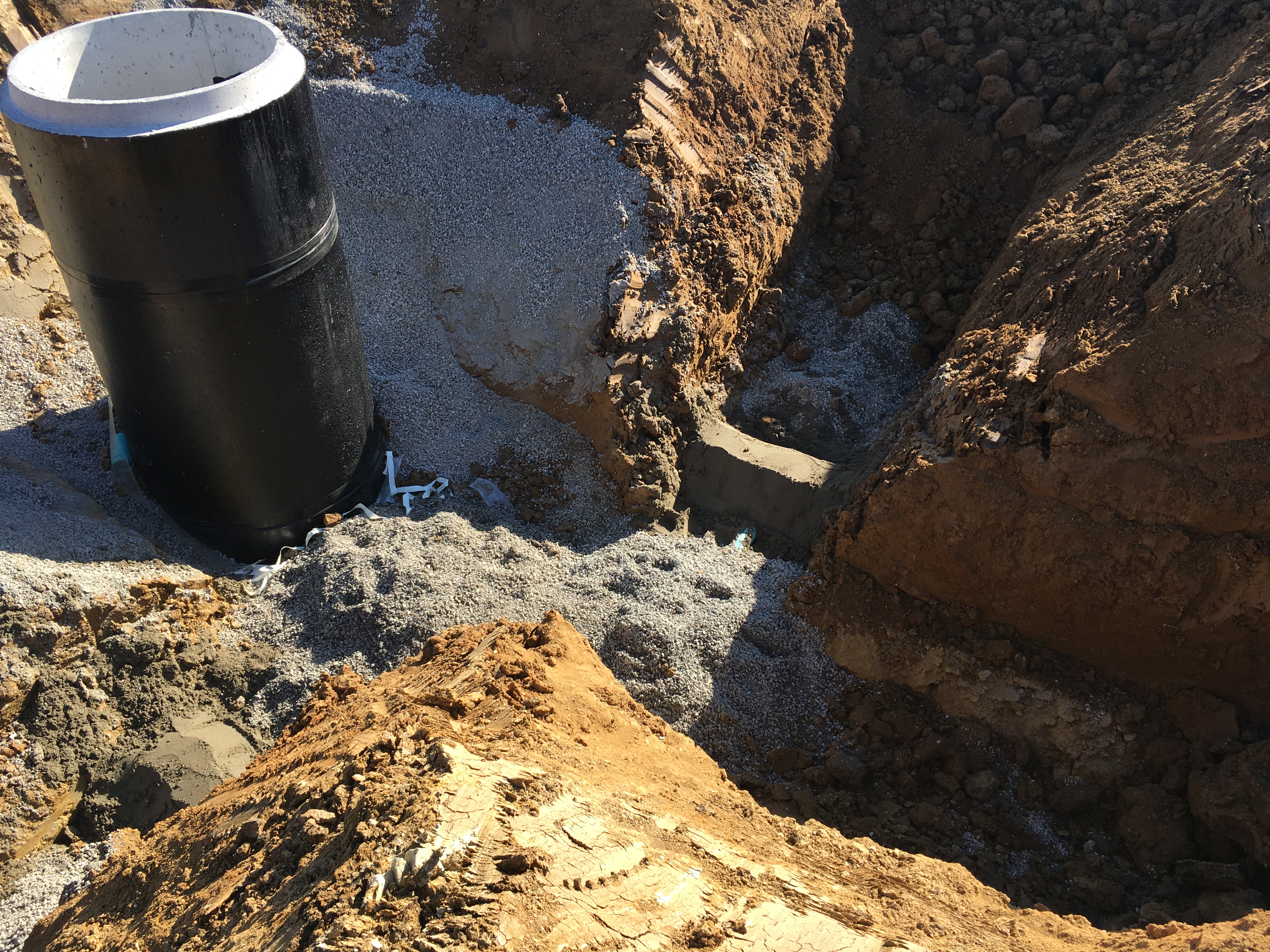

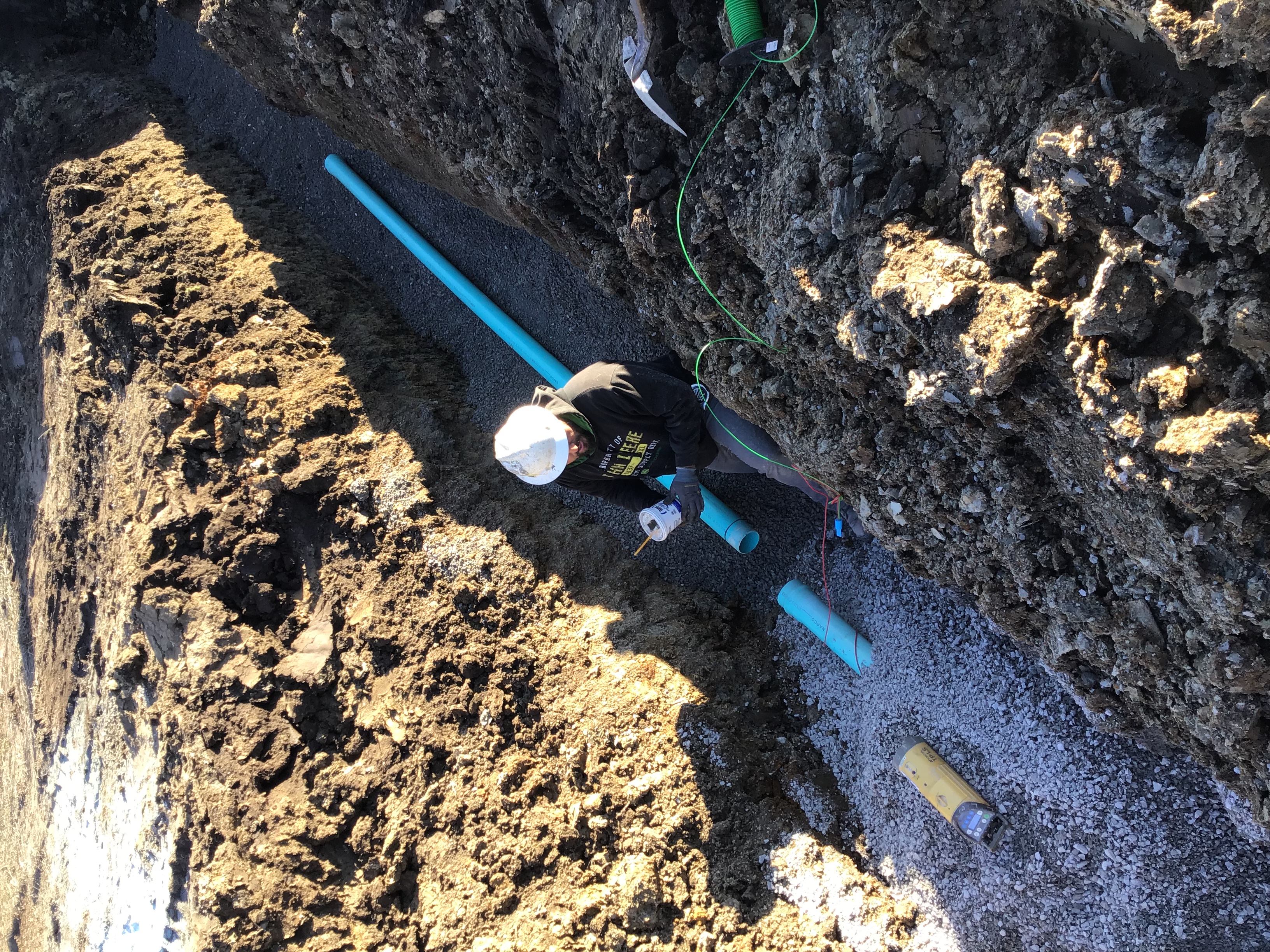

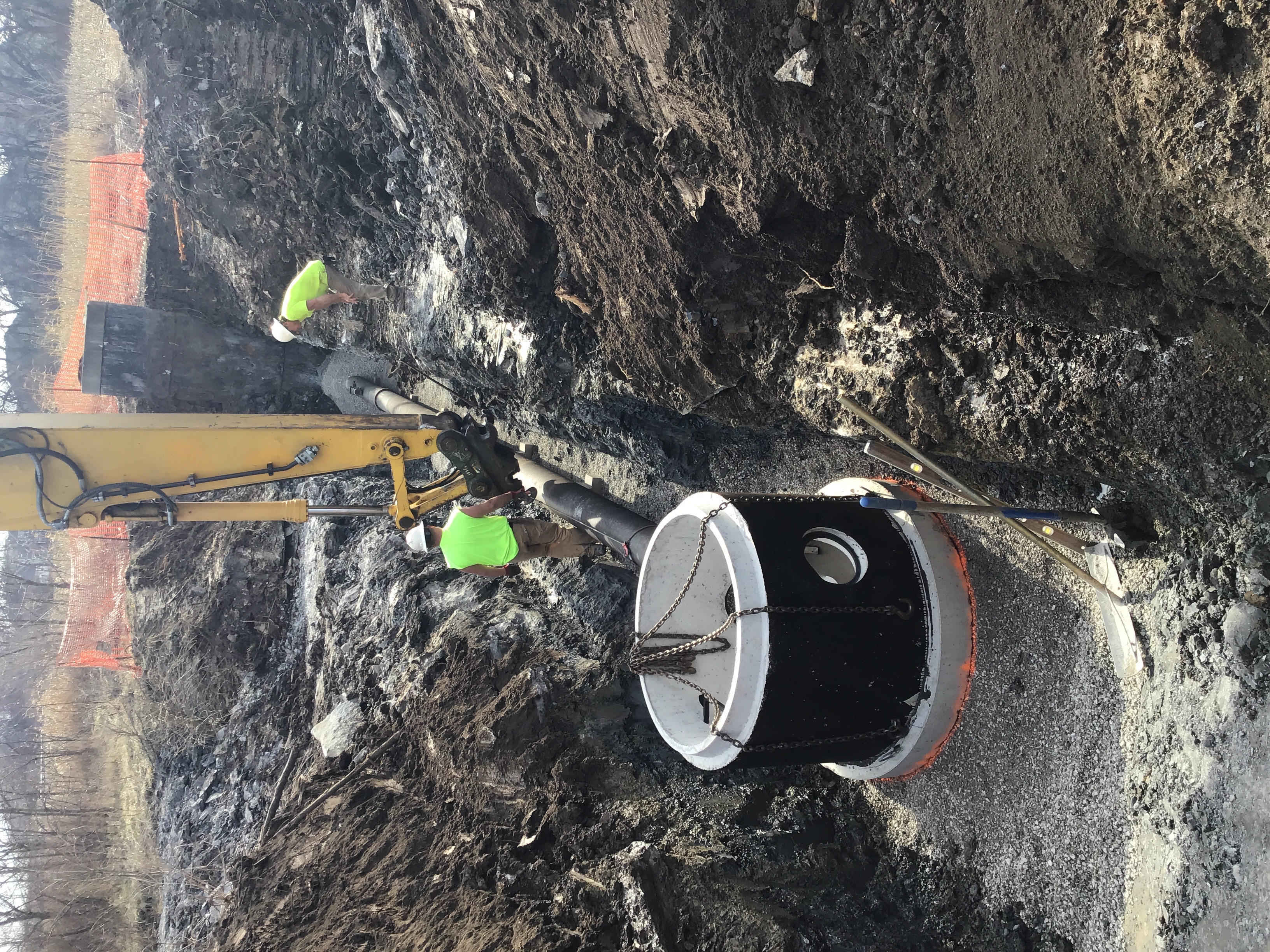

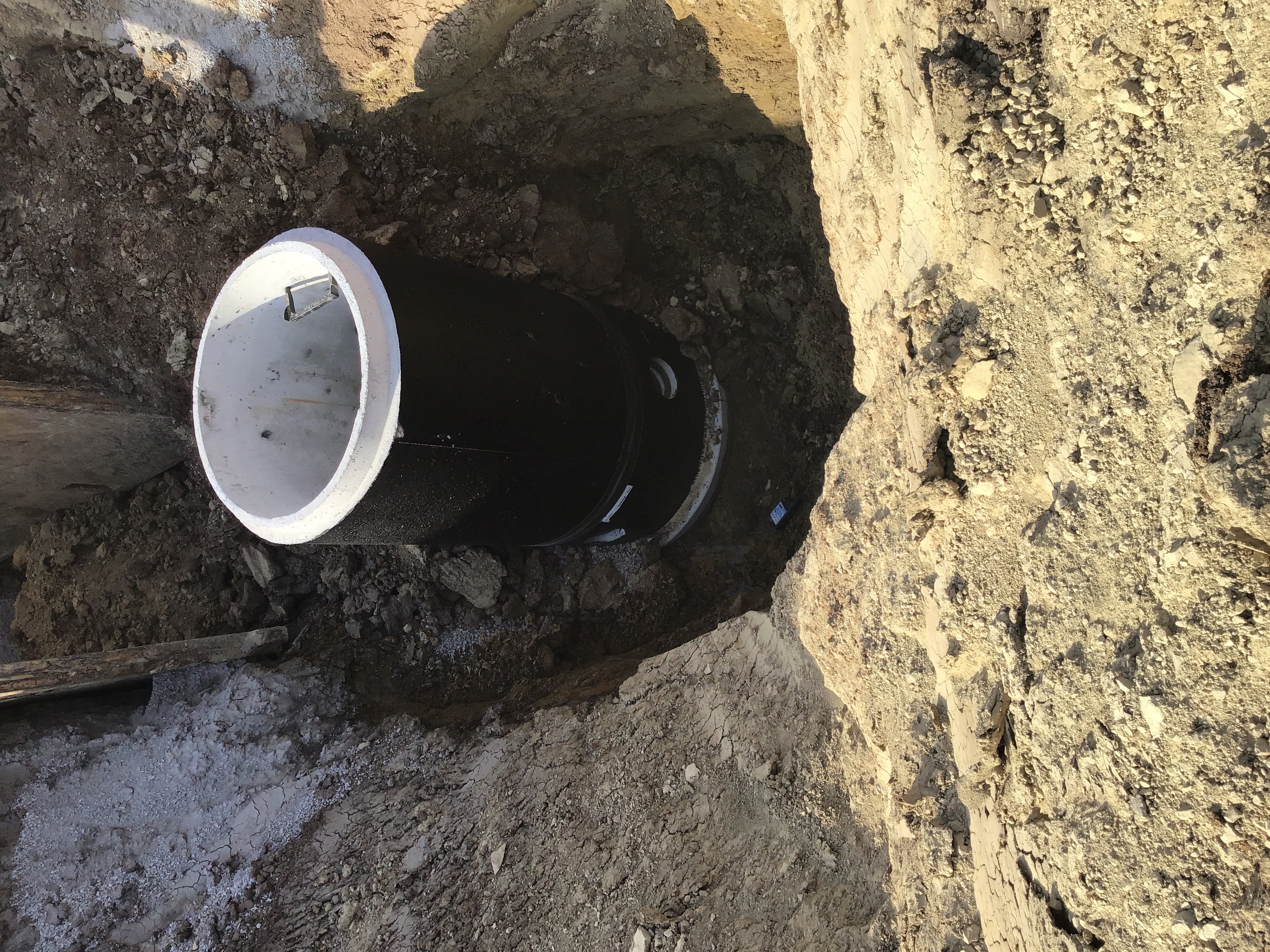

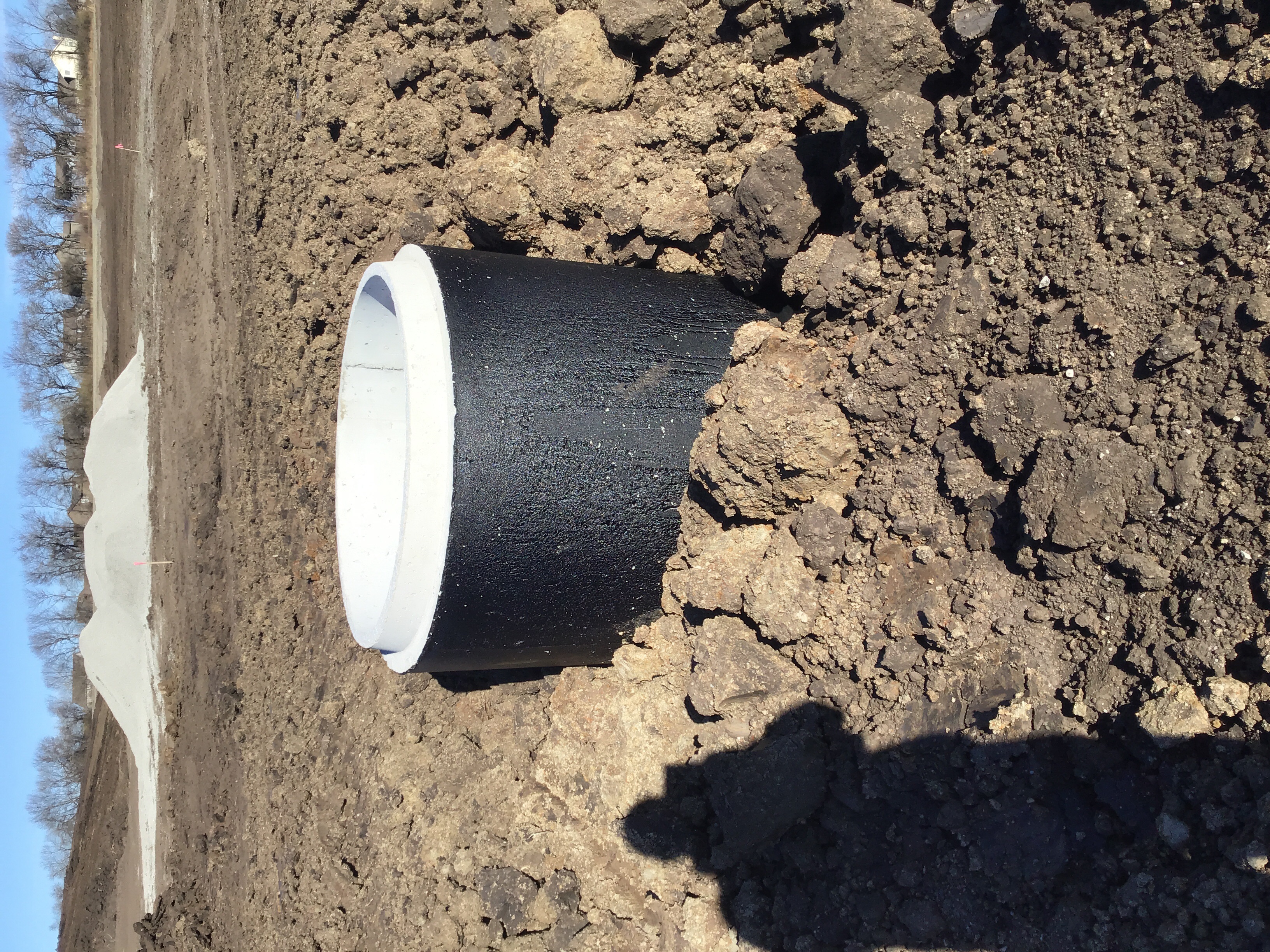

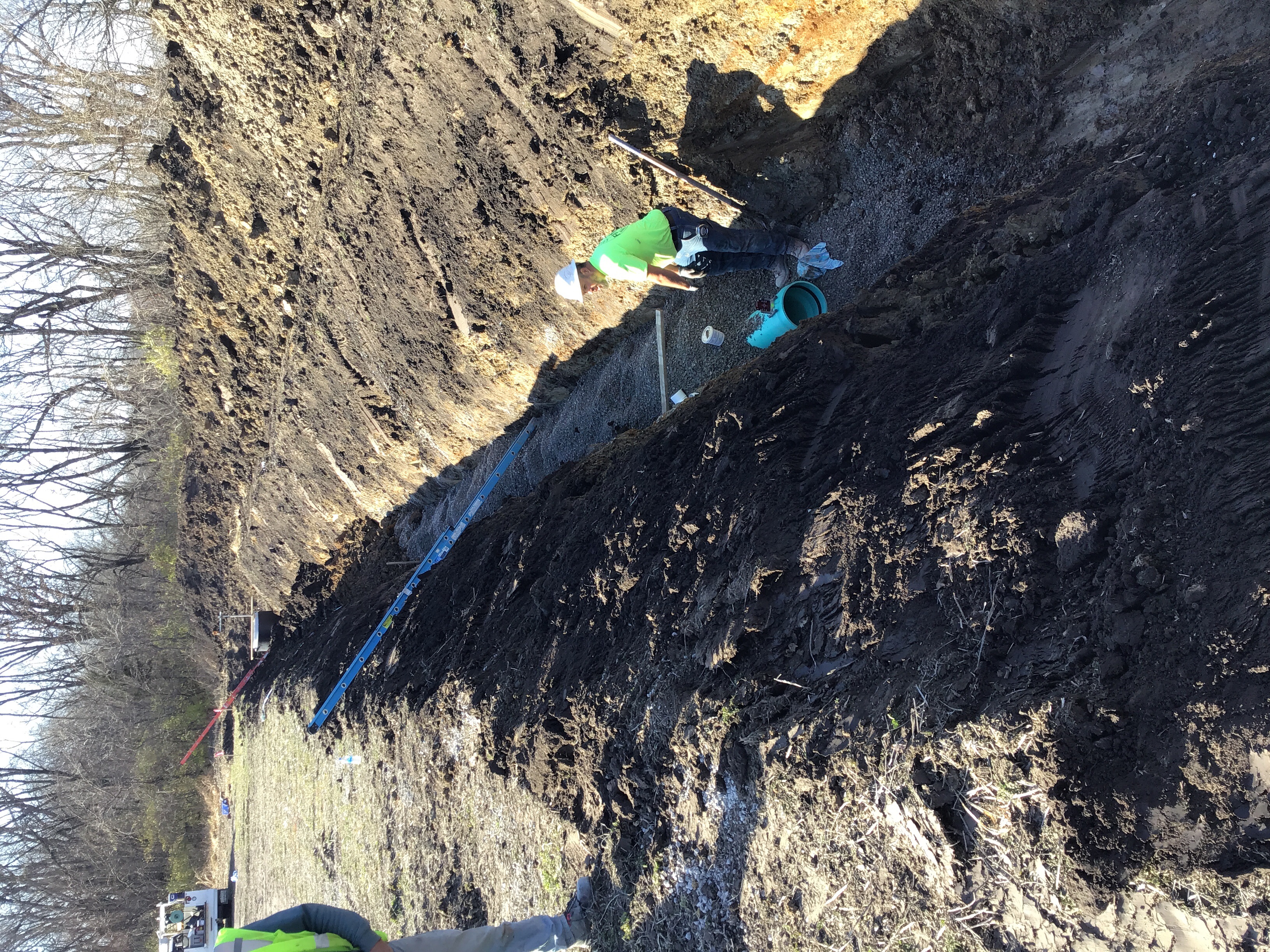

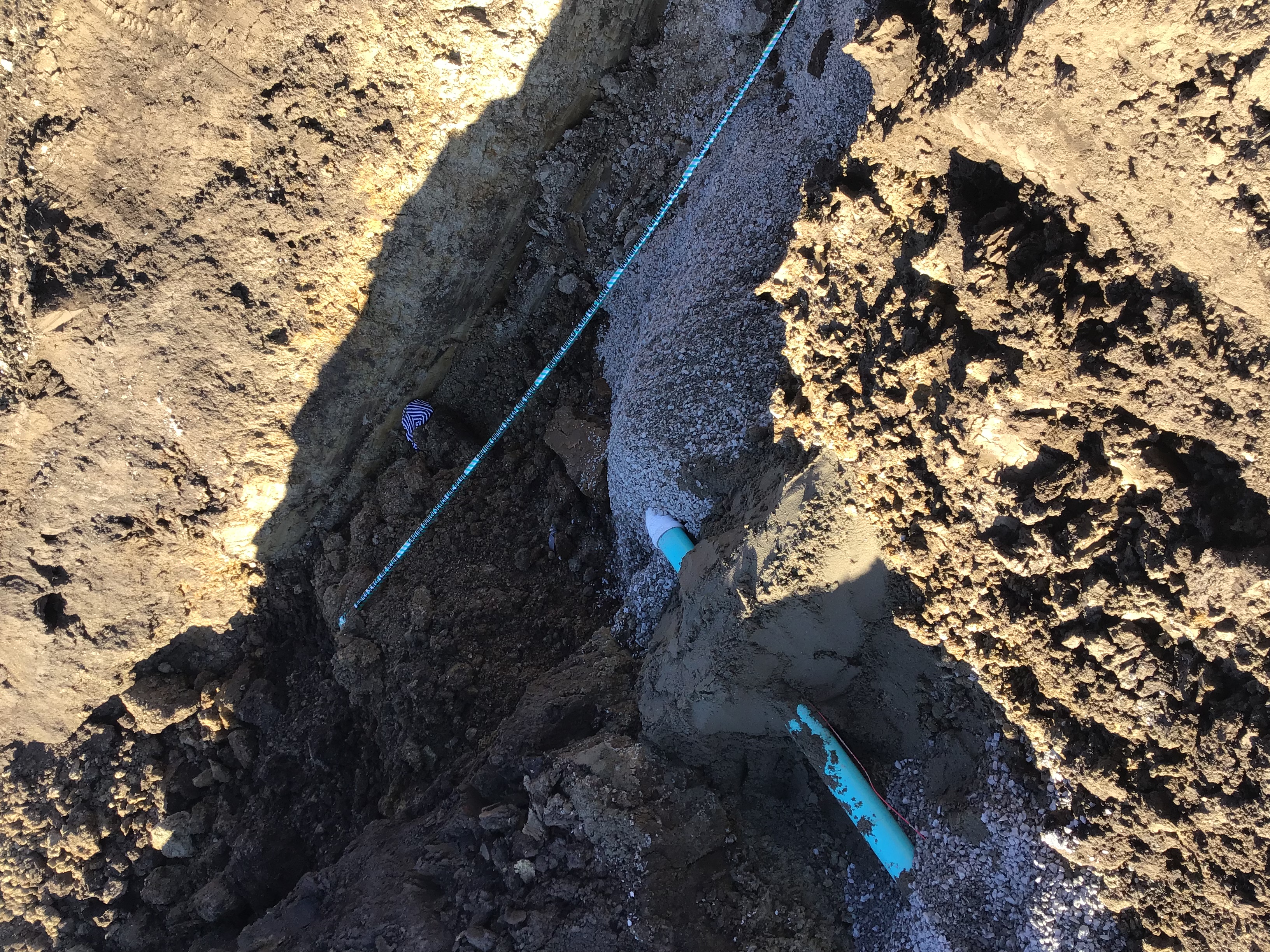

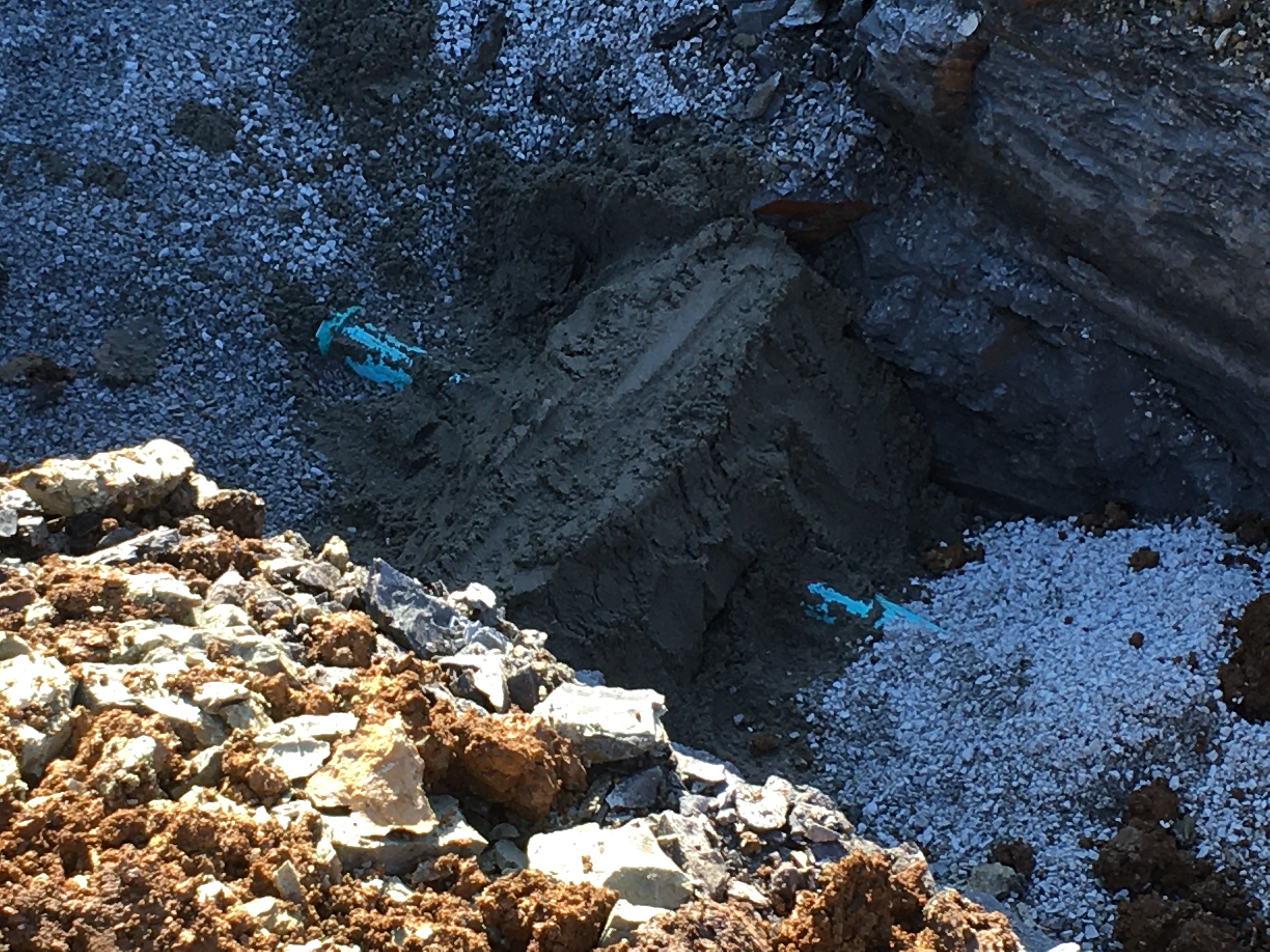

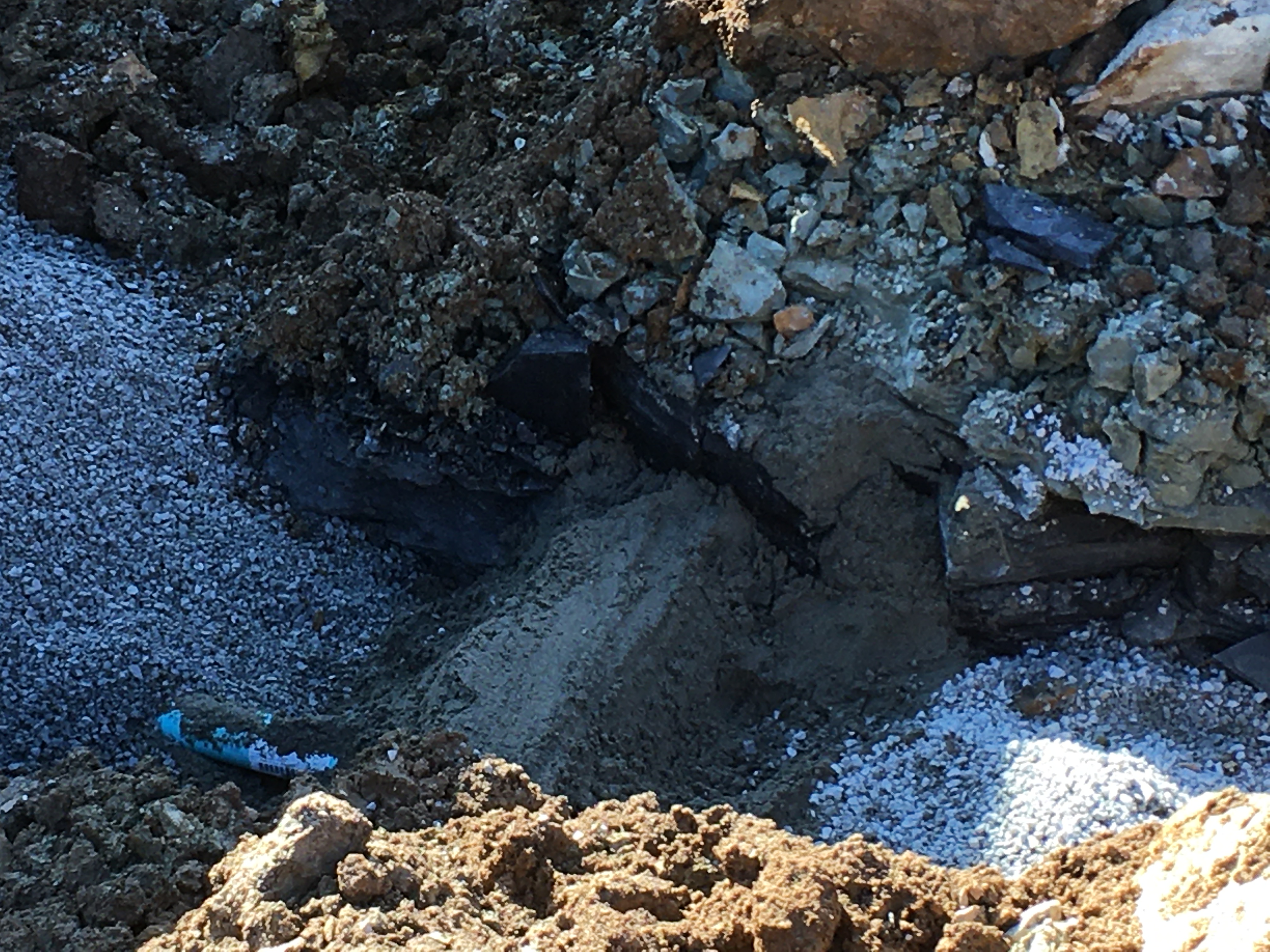

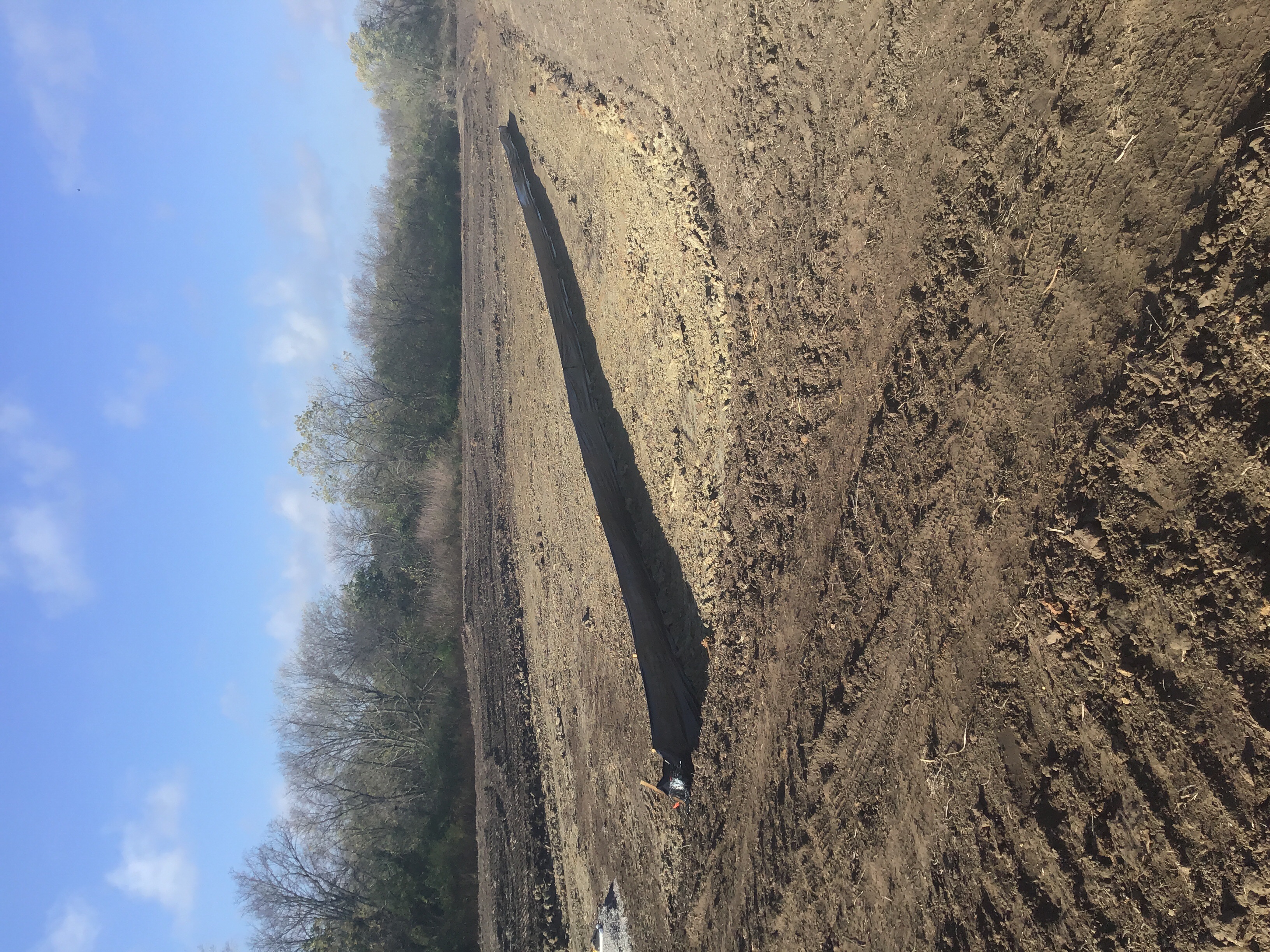

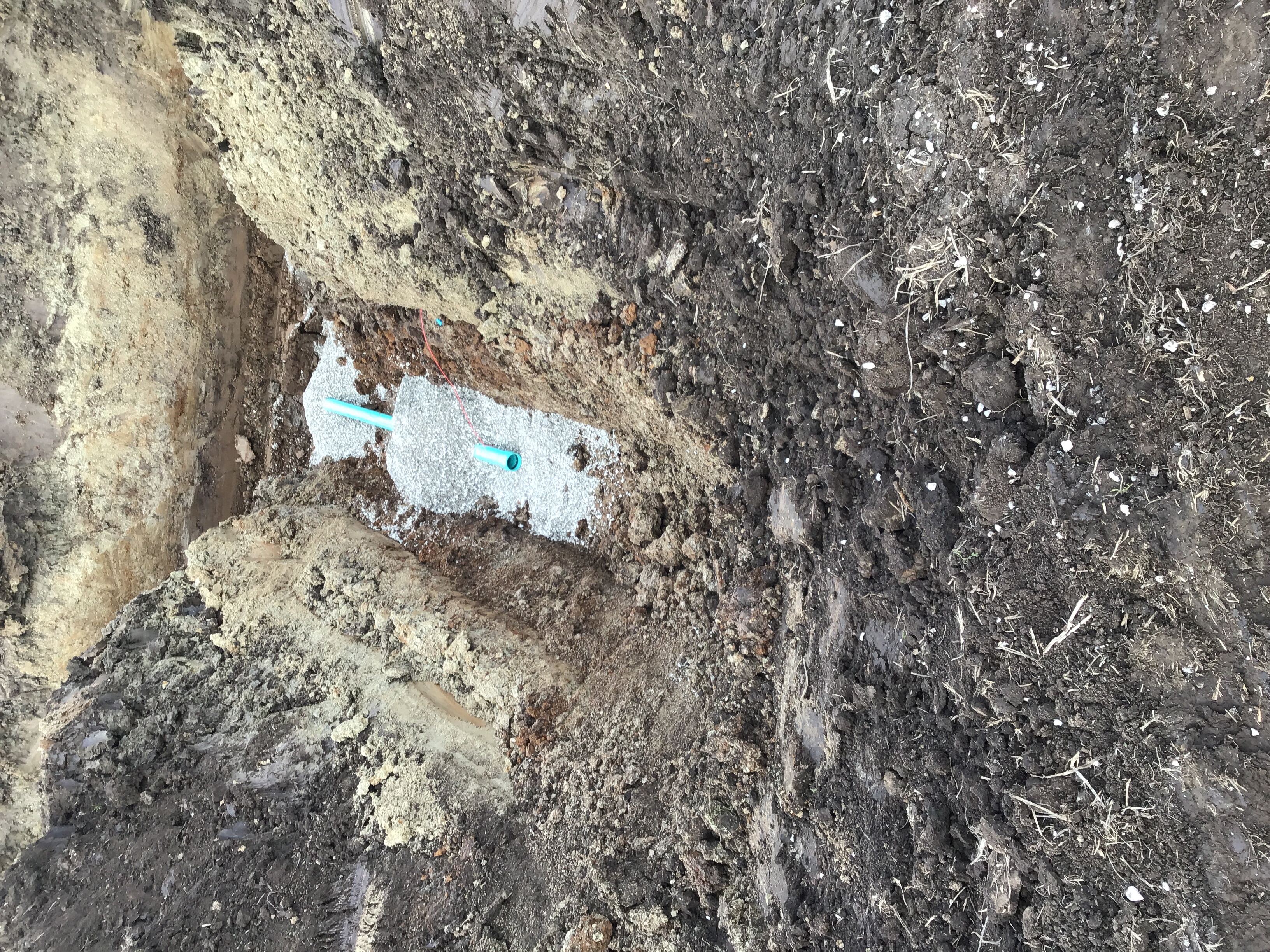

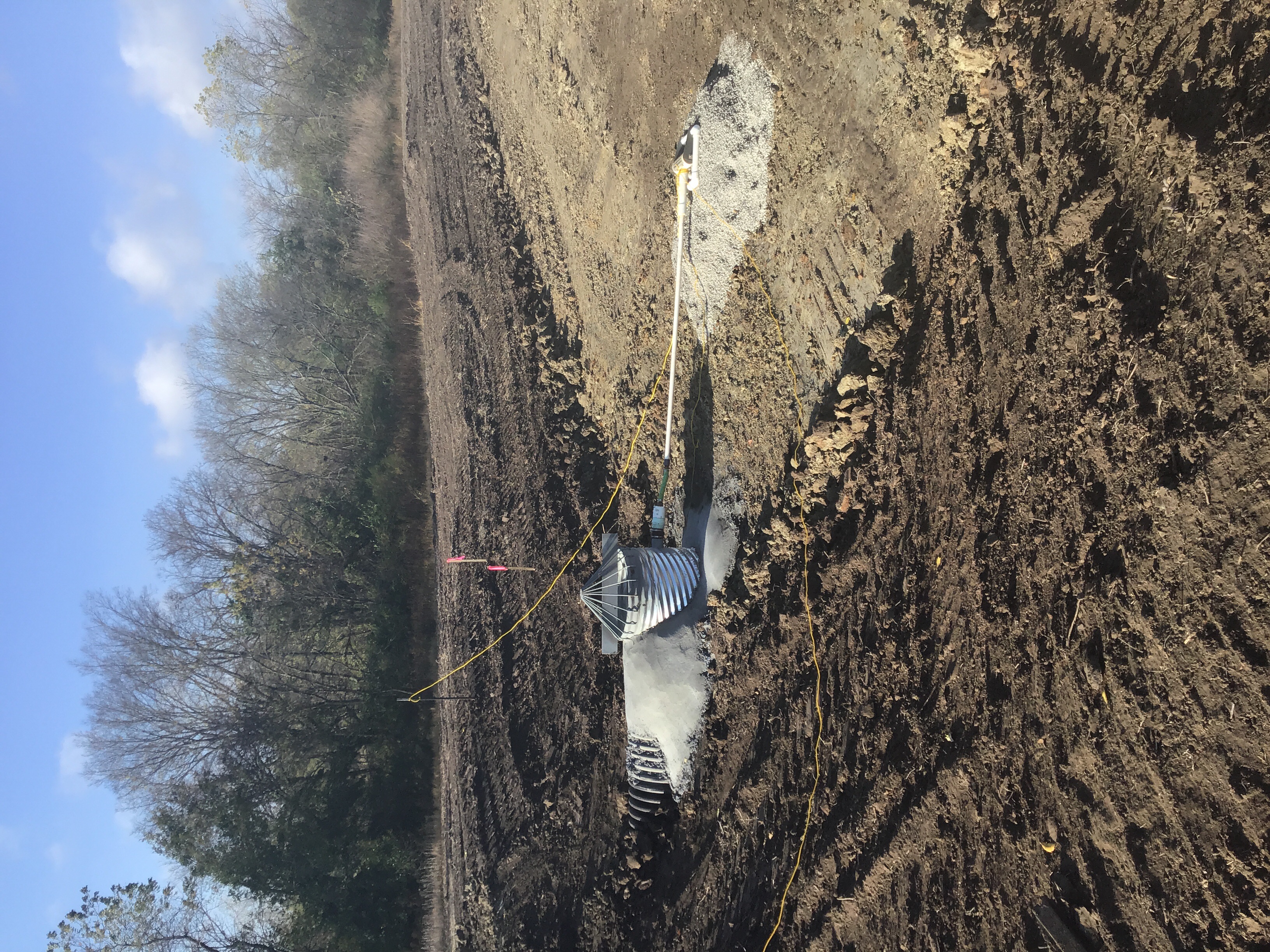

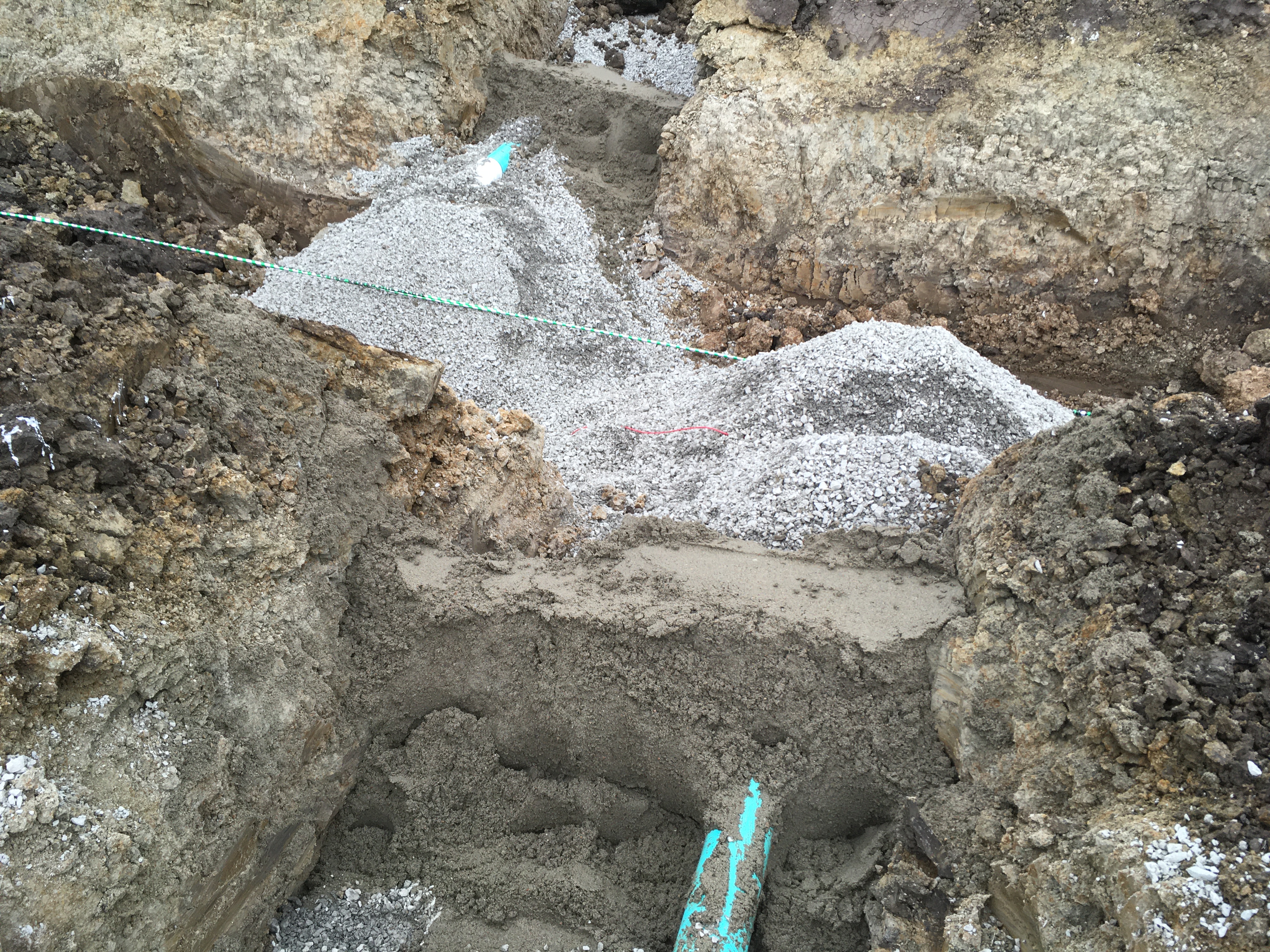

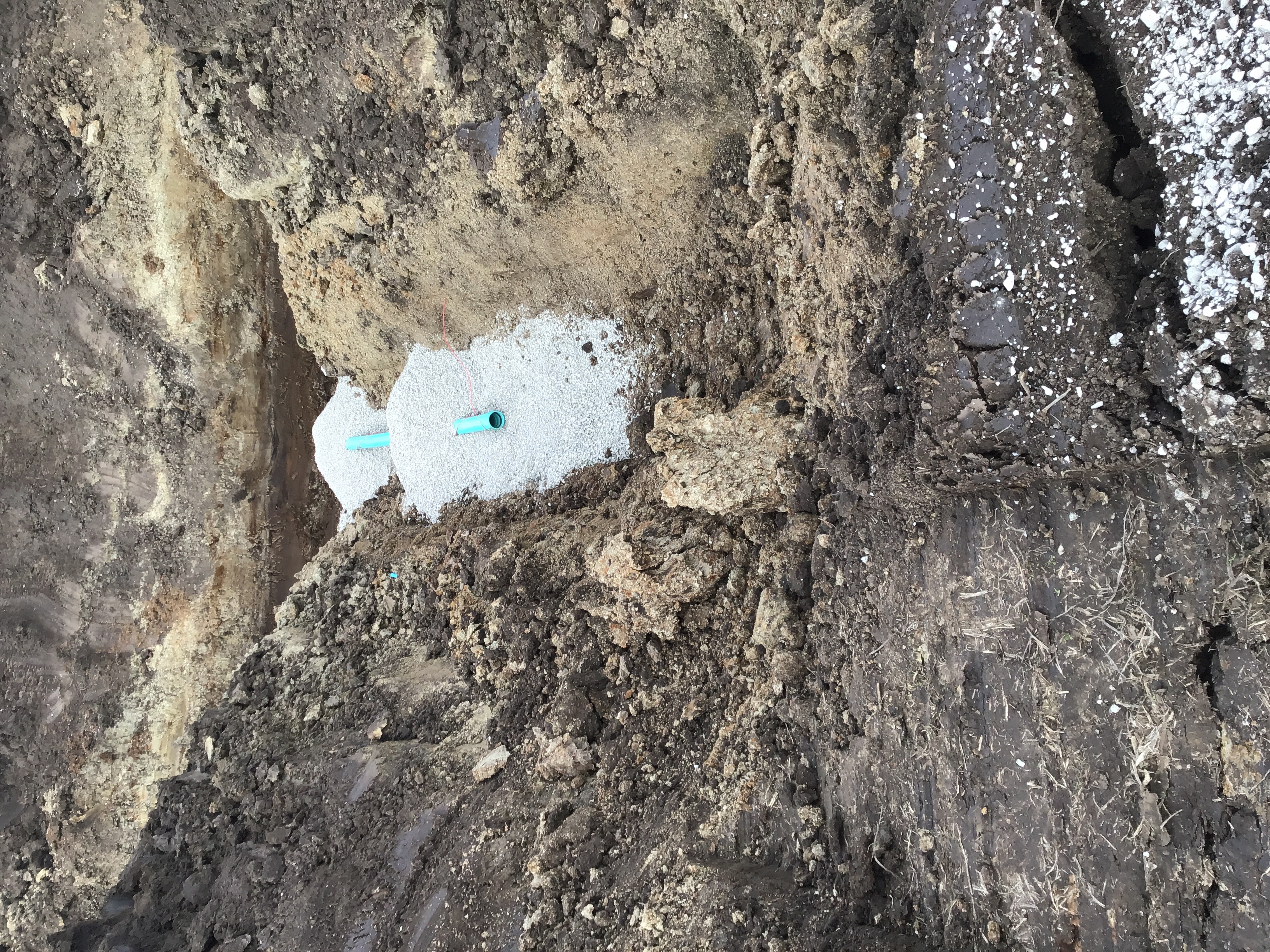

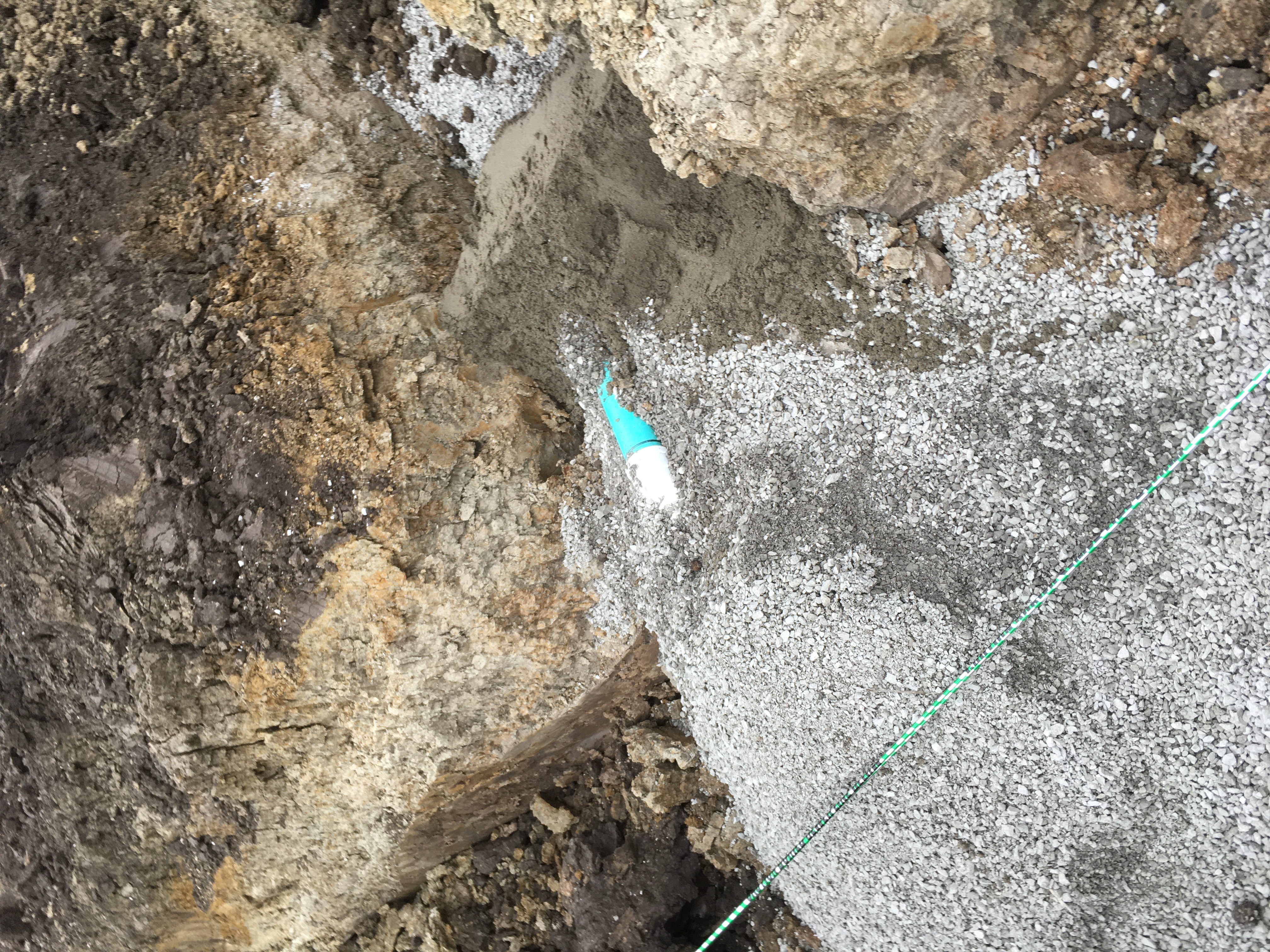

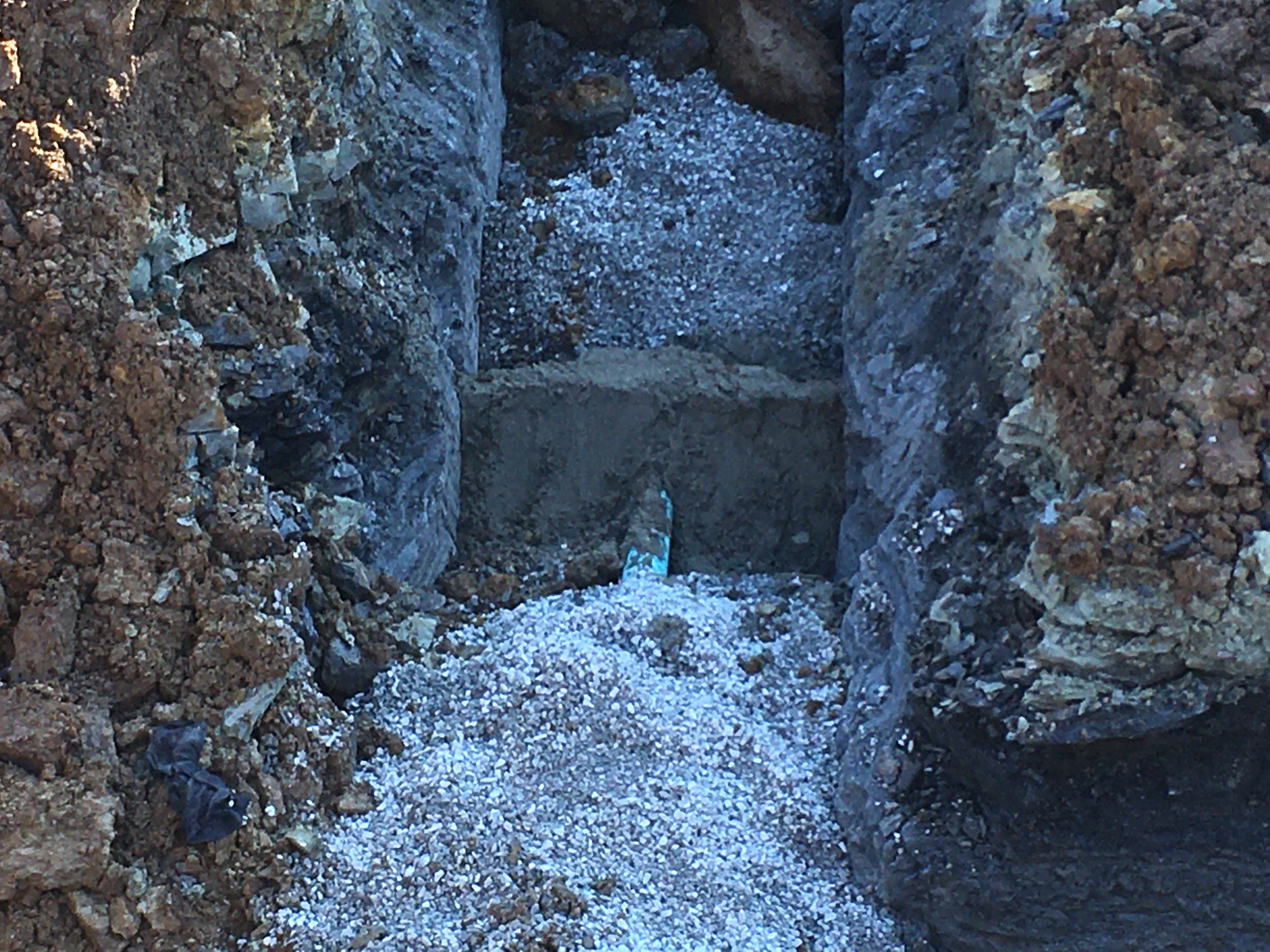

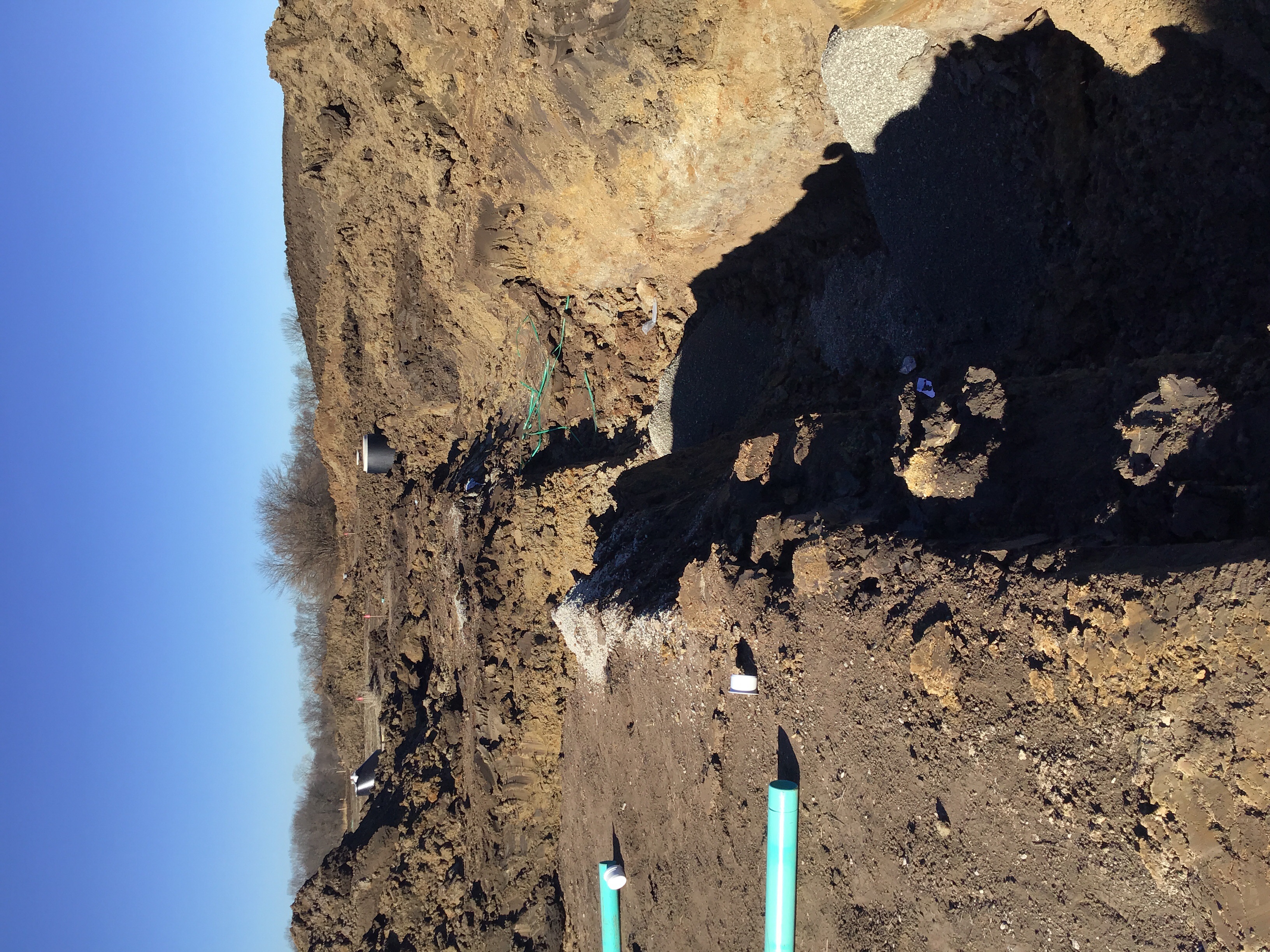

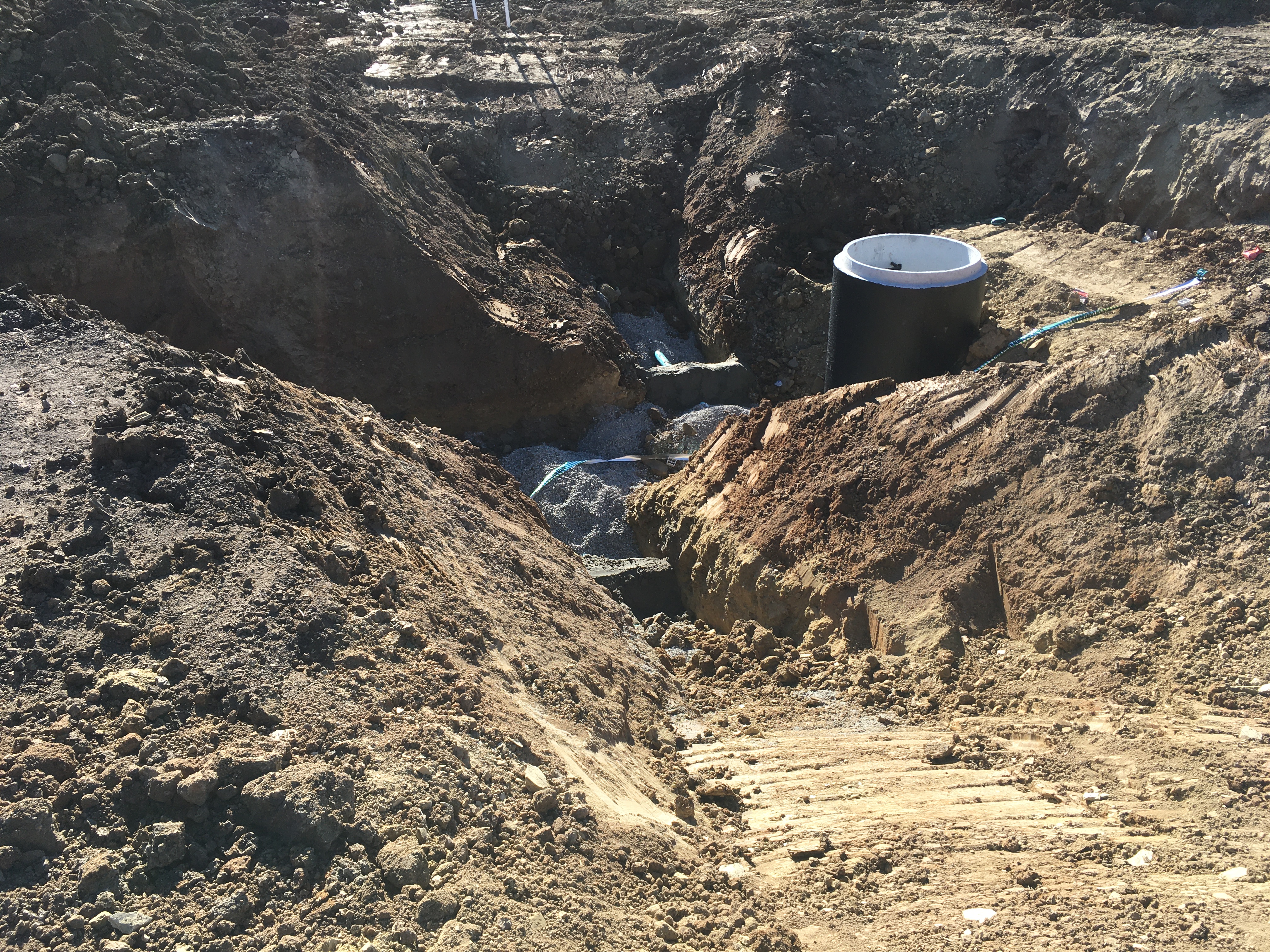

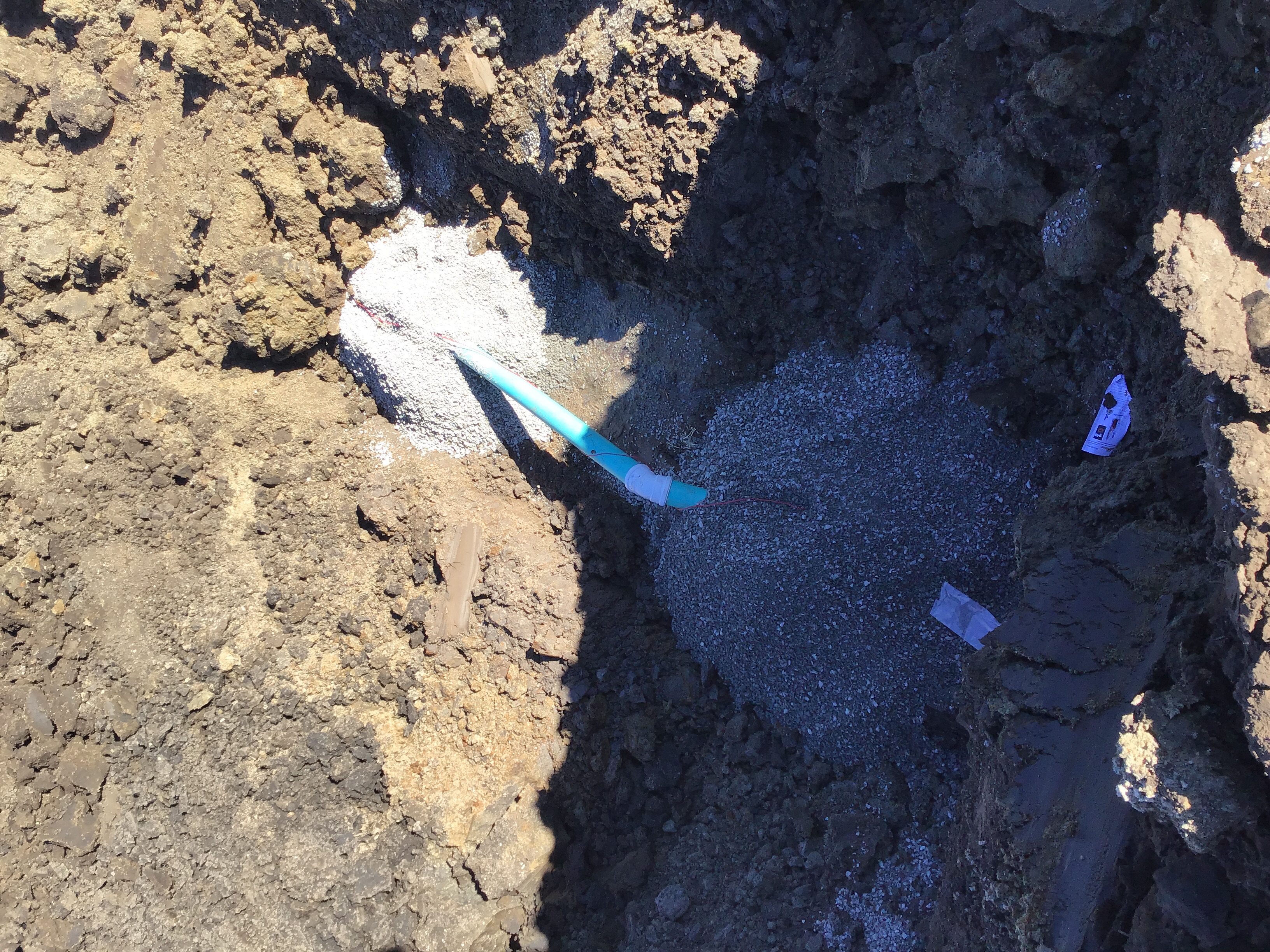

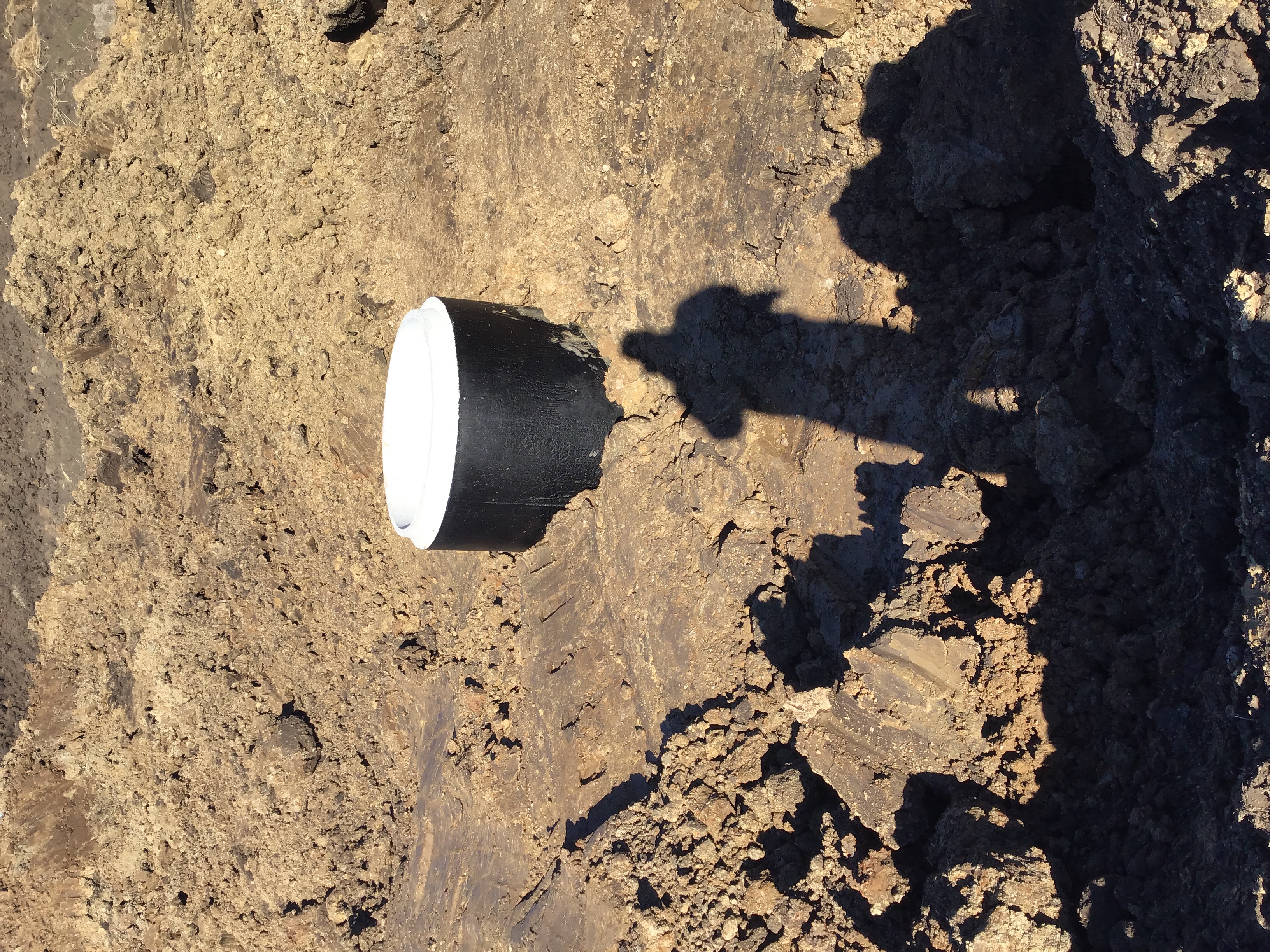

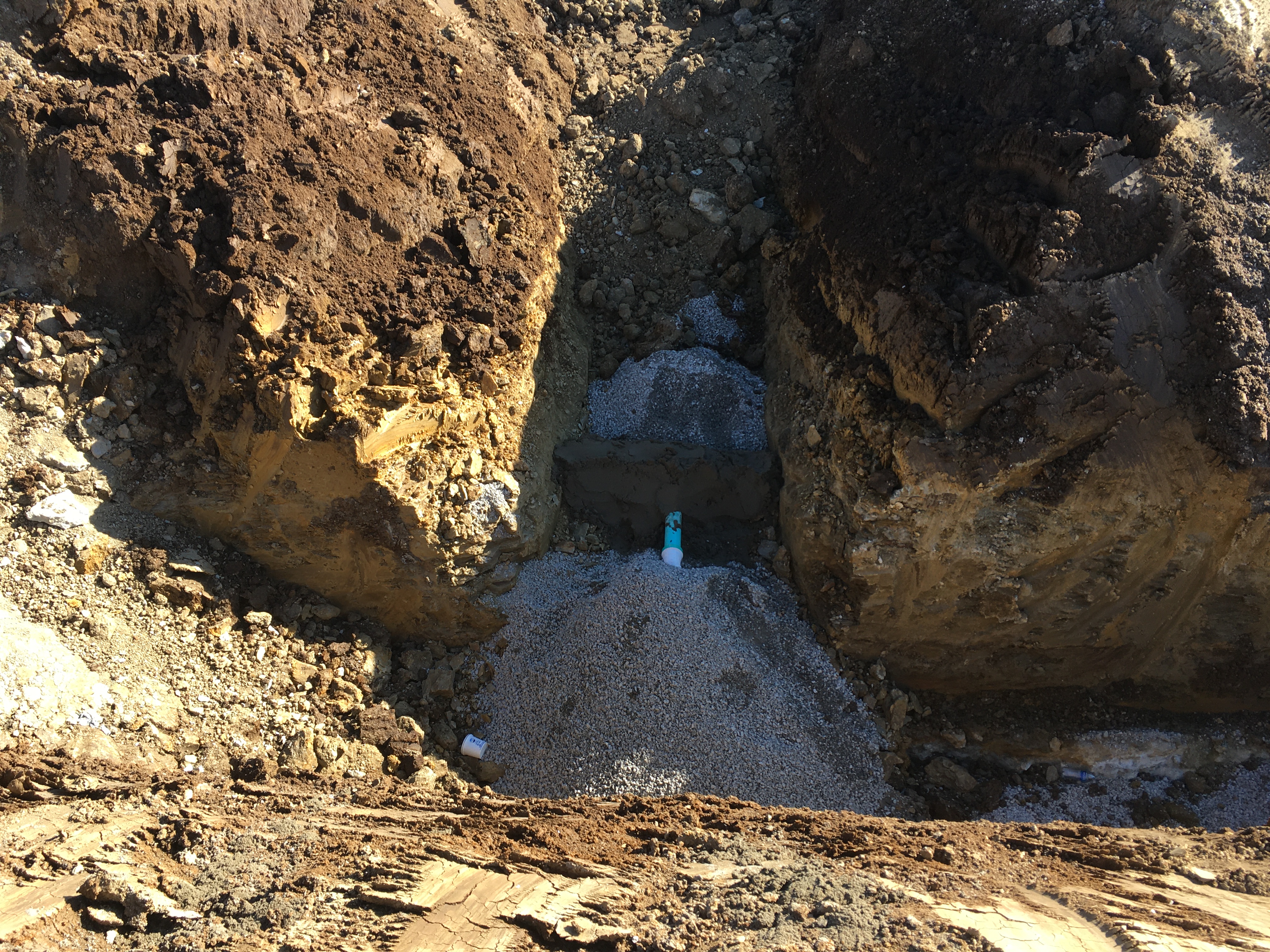

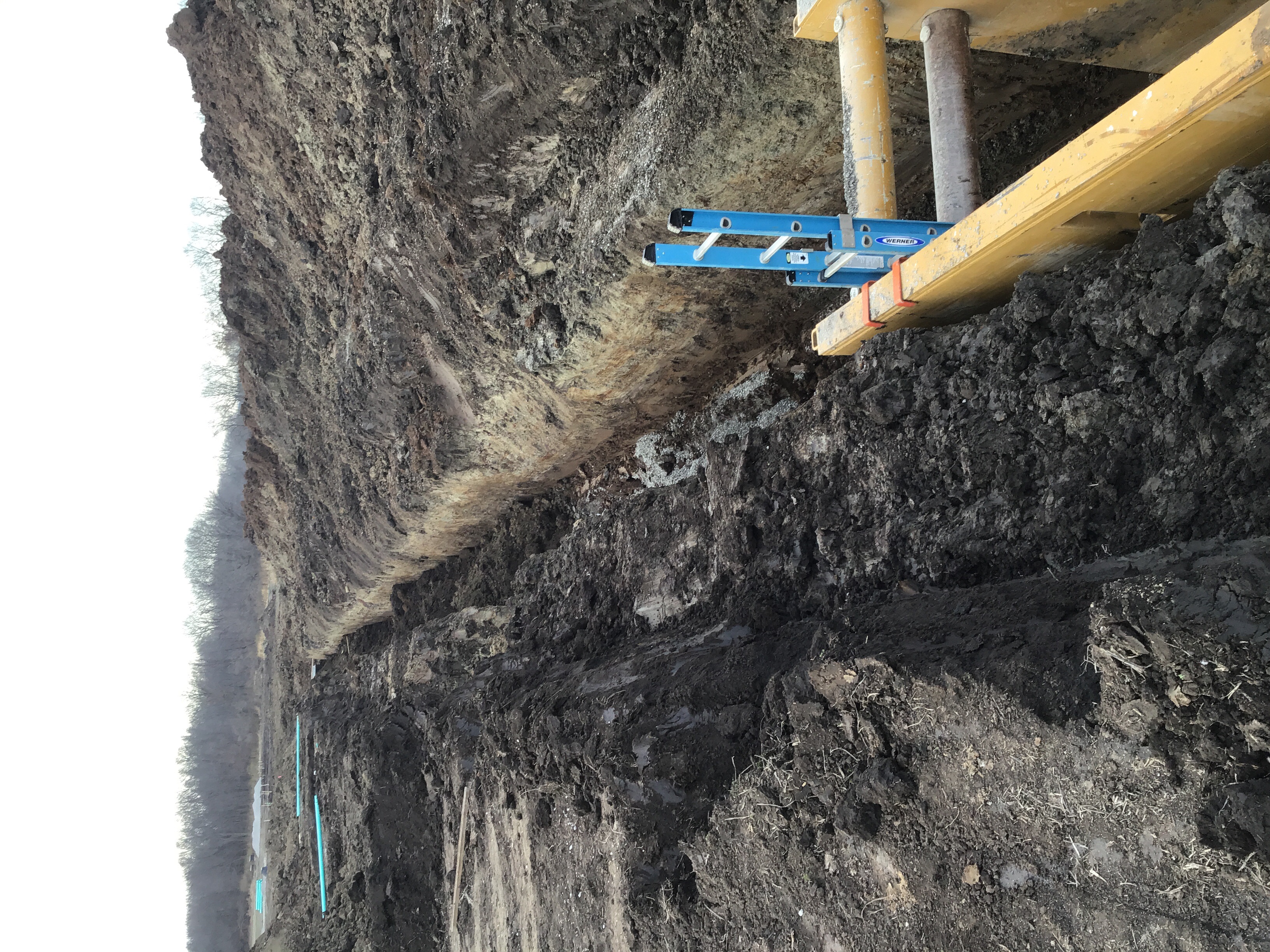

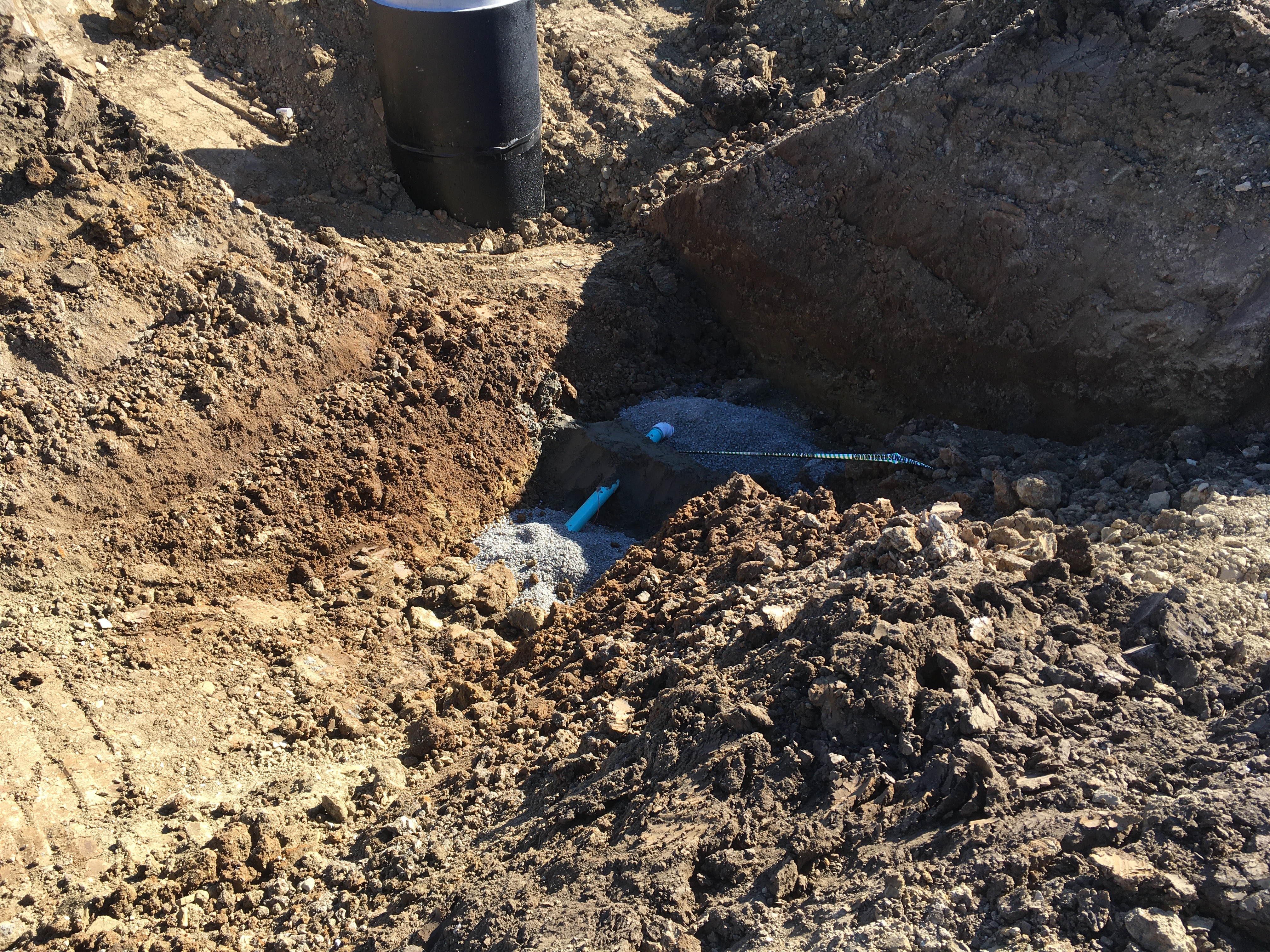

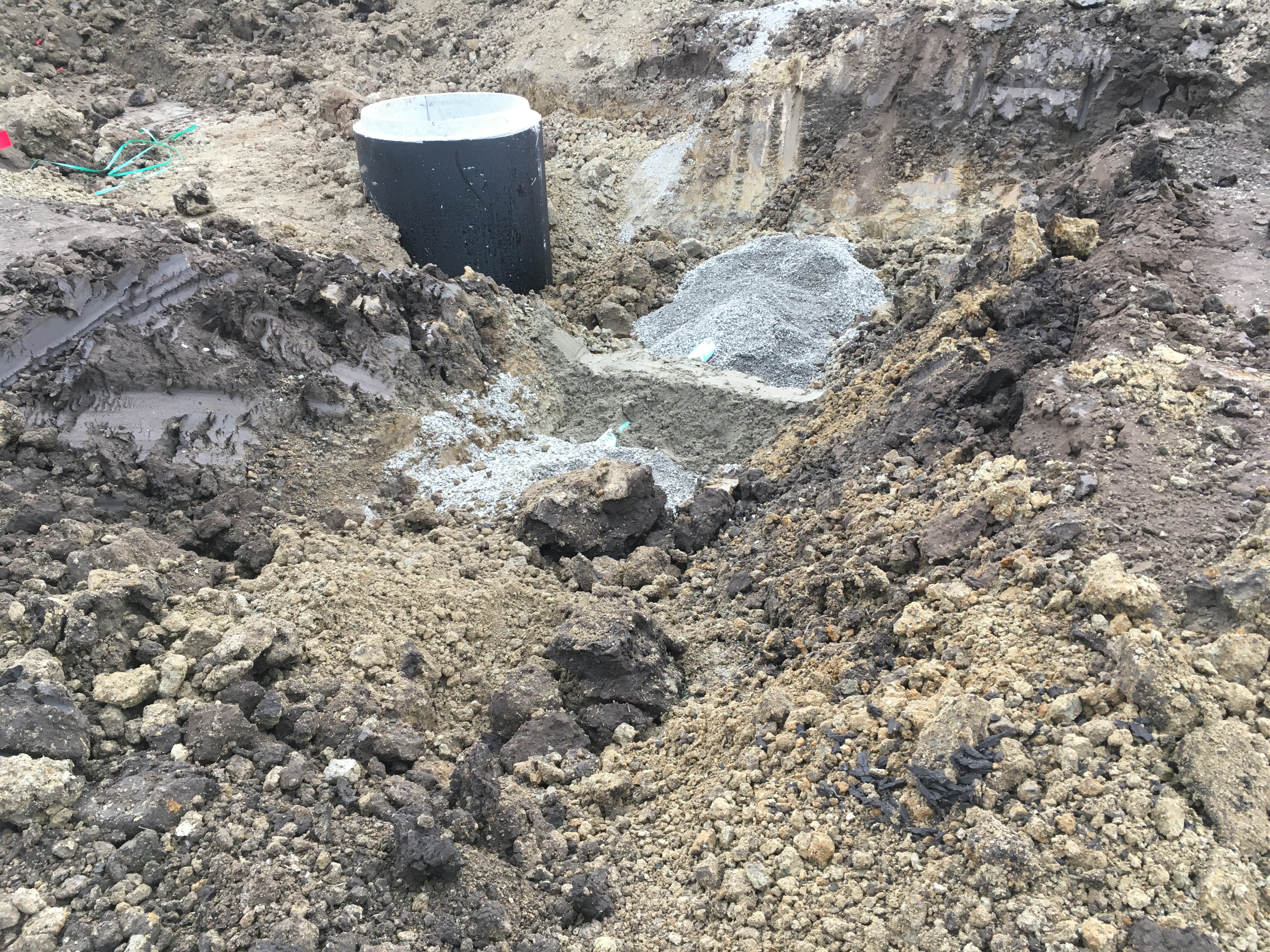

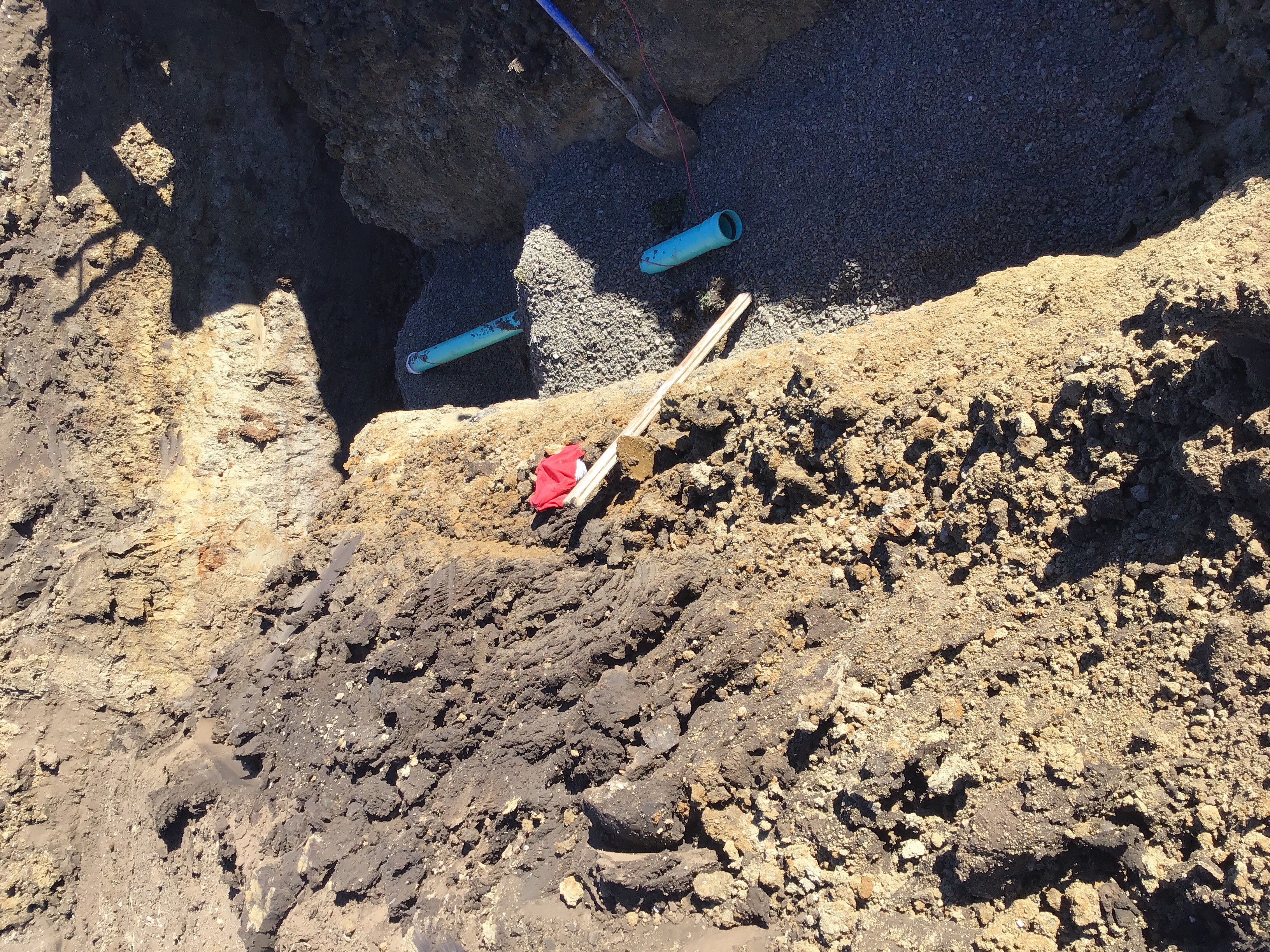

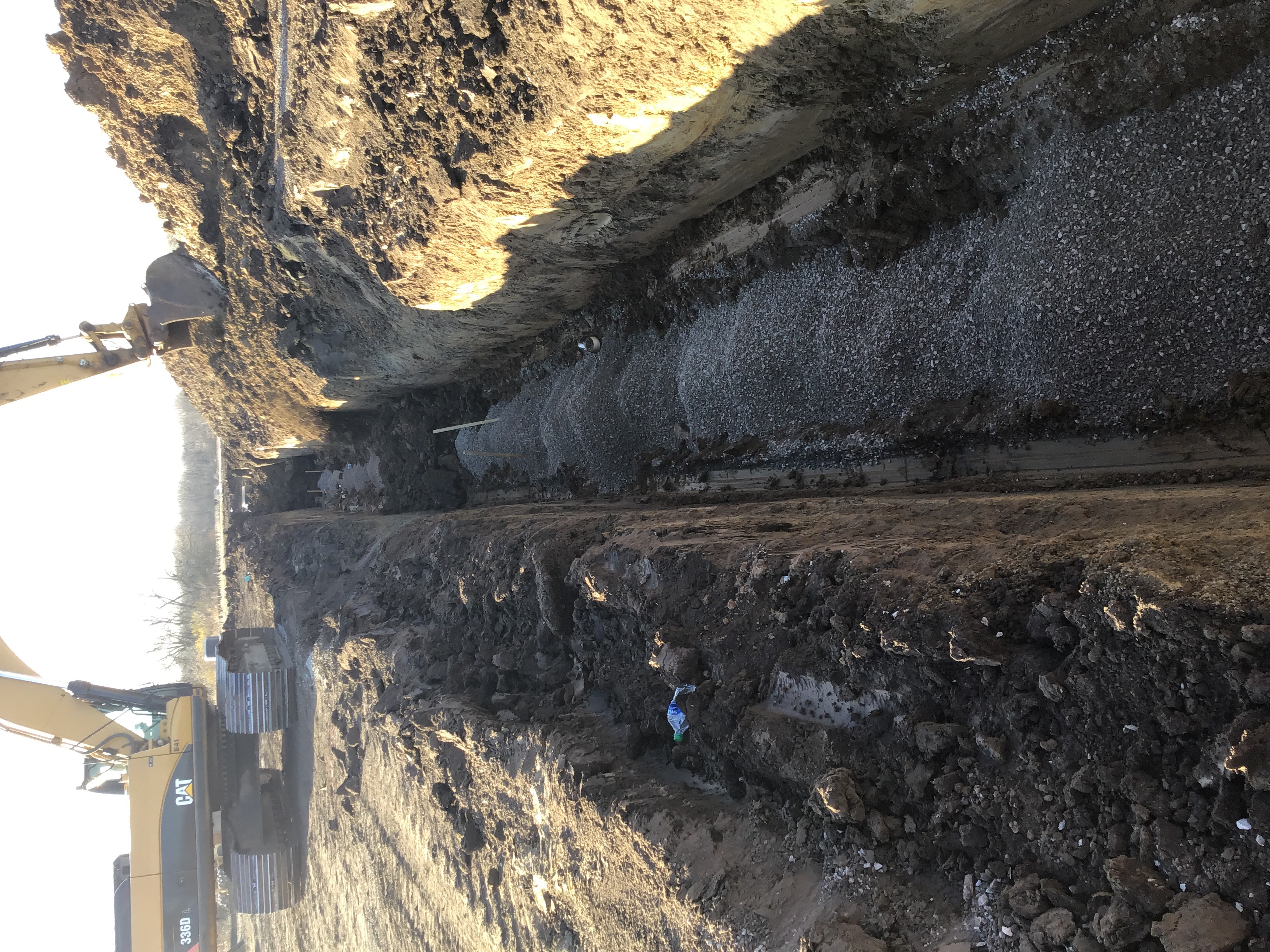

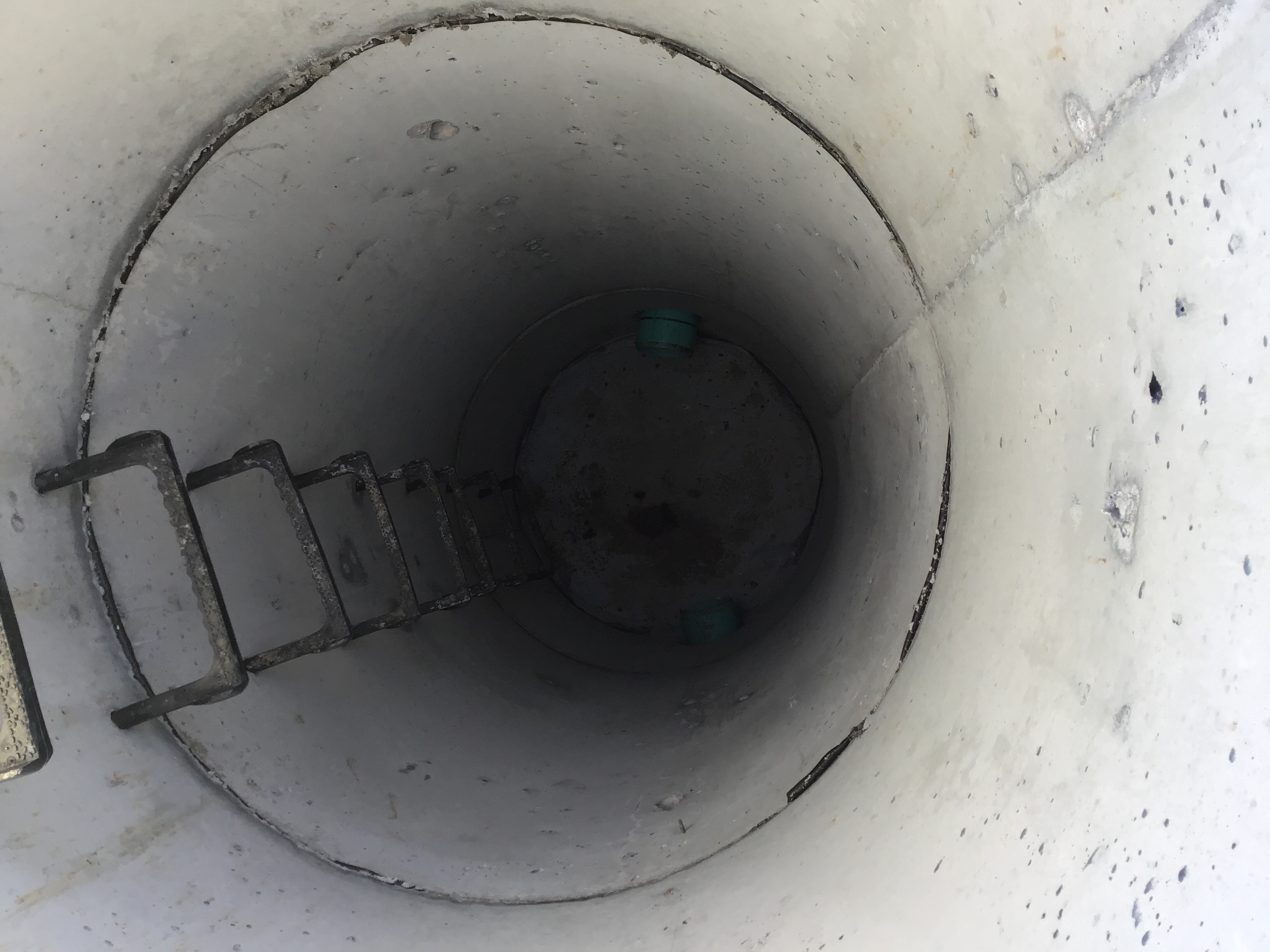

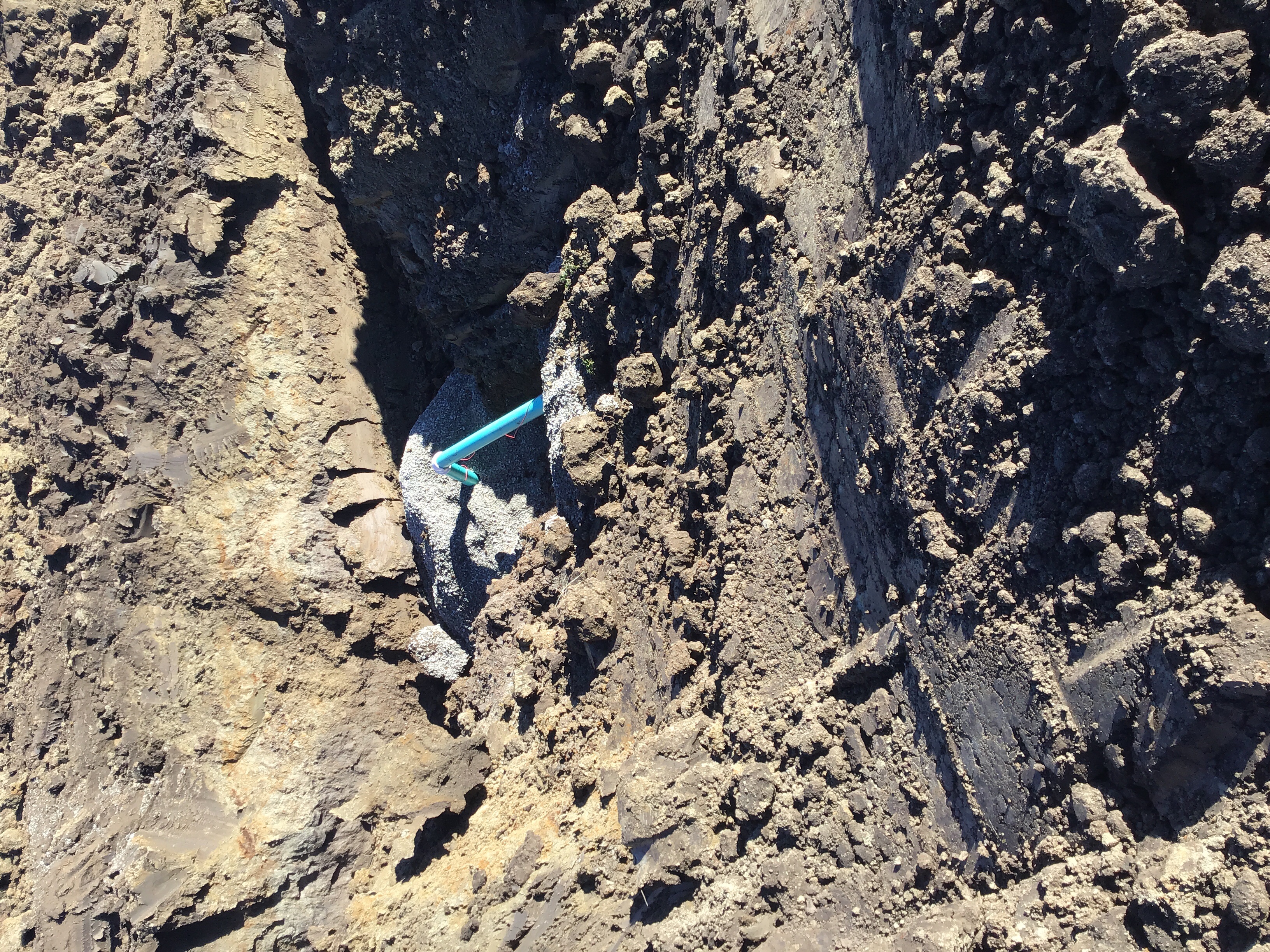

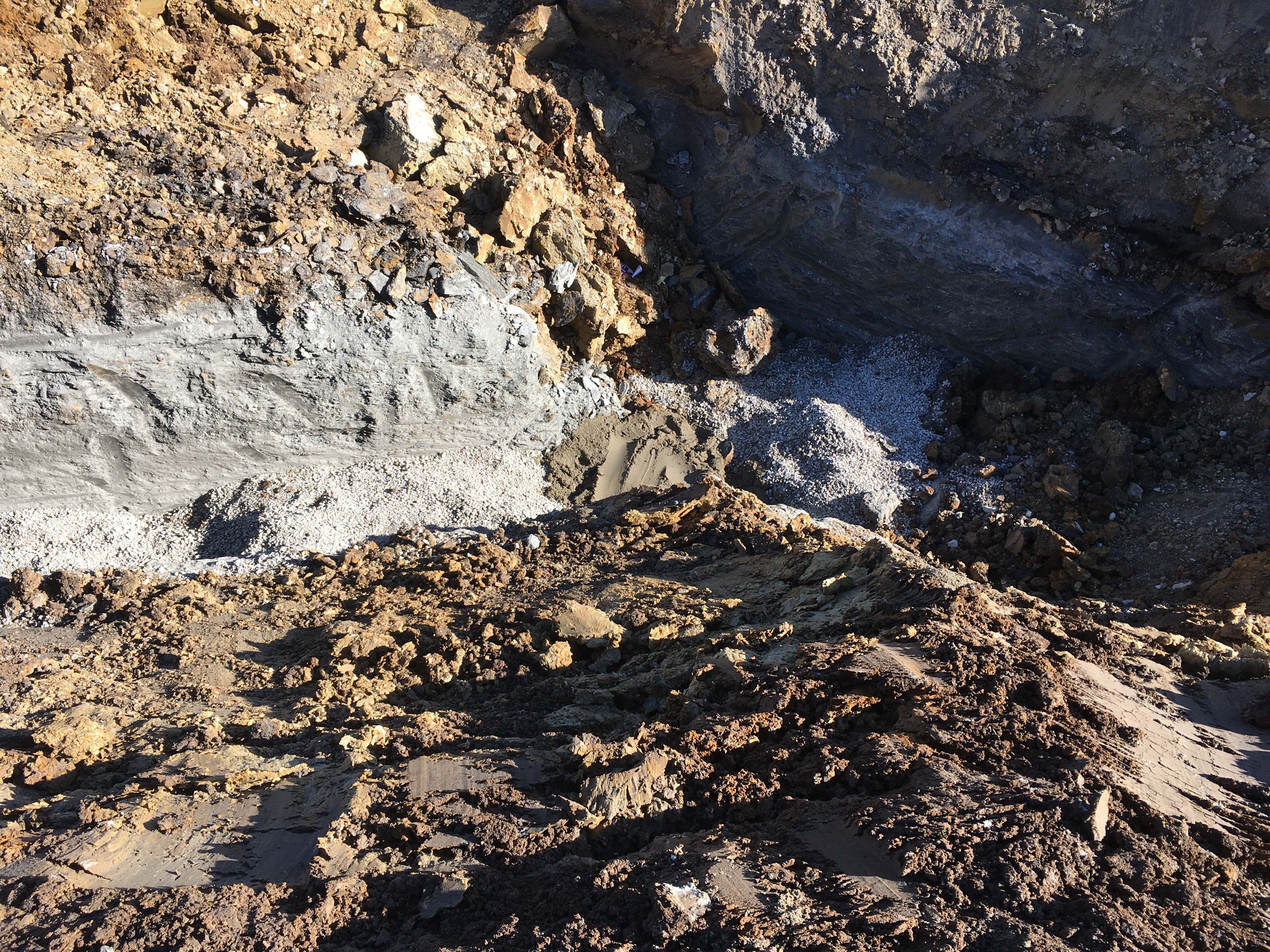

John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/01/2020
Misc
Informational
12/01/2020

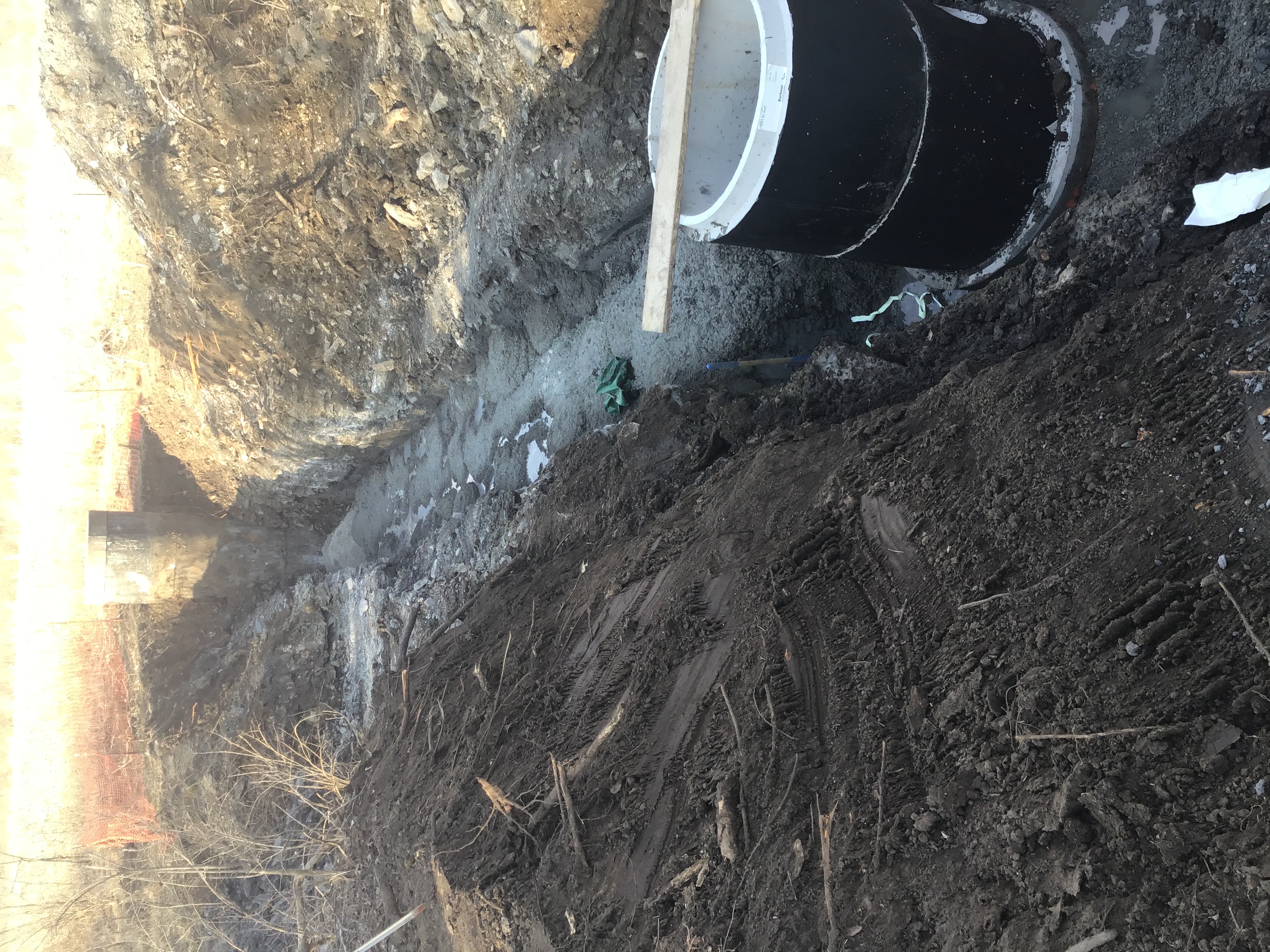

John DiMauro 12/01/2020 2:42 PM The Redford crew is currently working sanitary line 1. The crew has MH 1-4 set and the line installed up to approximately station 22+00. The service laterals are installed up to lot 109. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/02/2020
Misc
Informational
12/01/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/02/2020

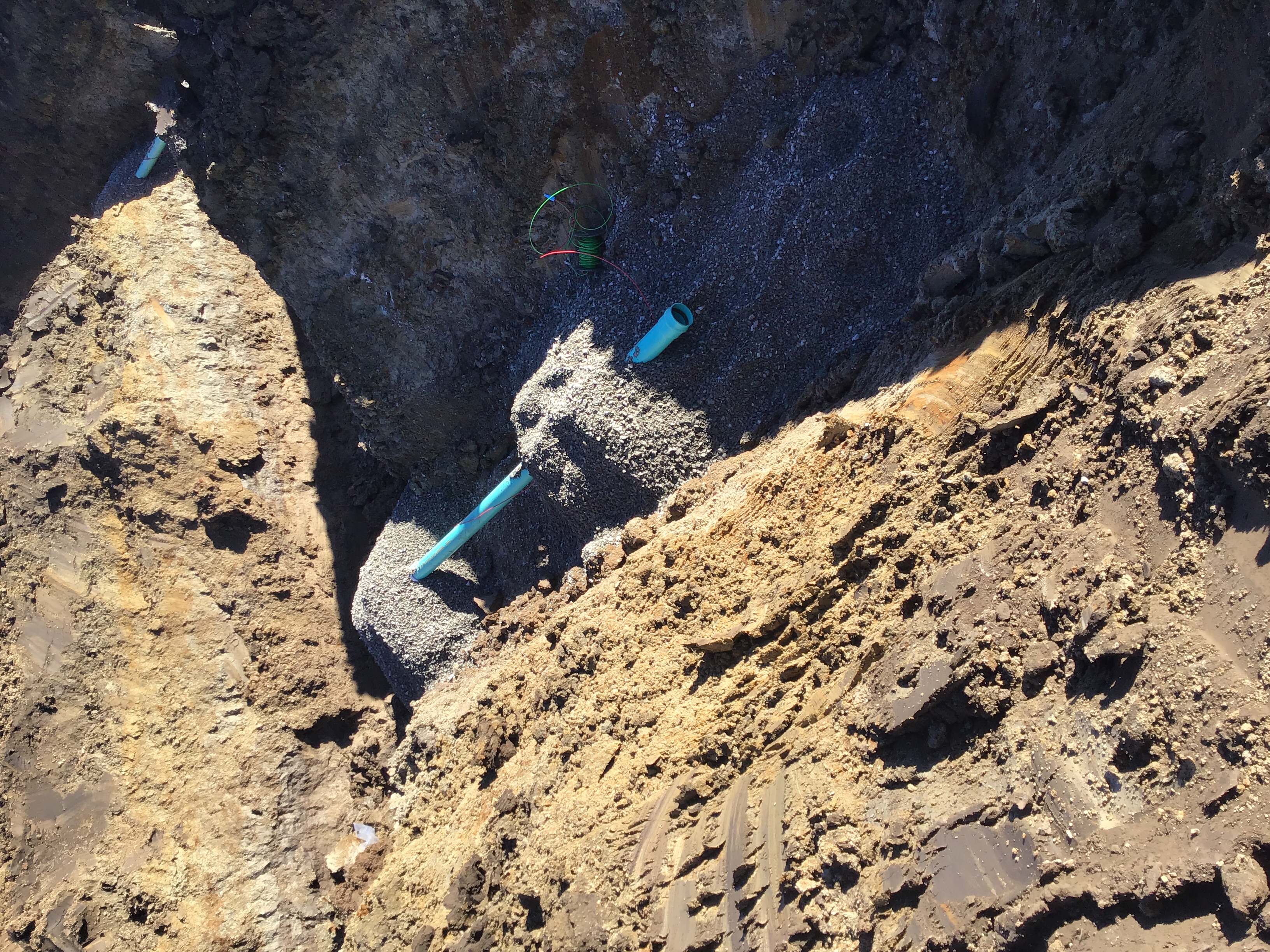

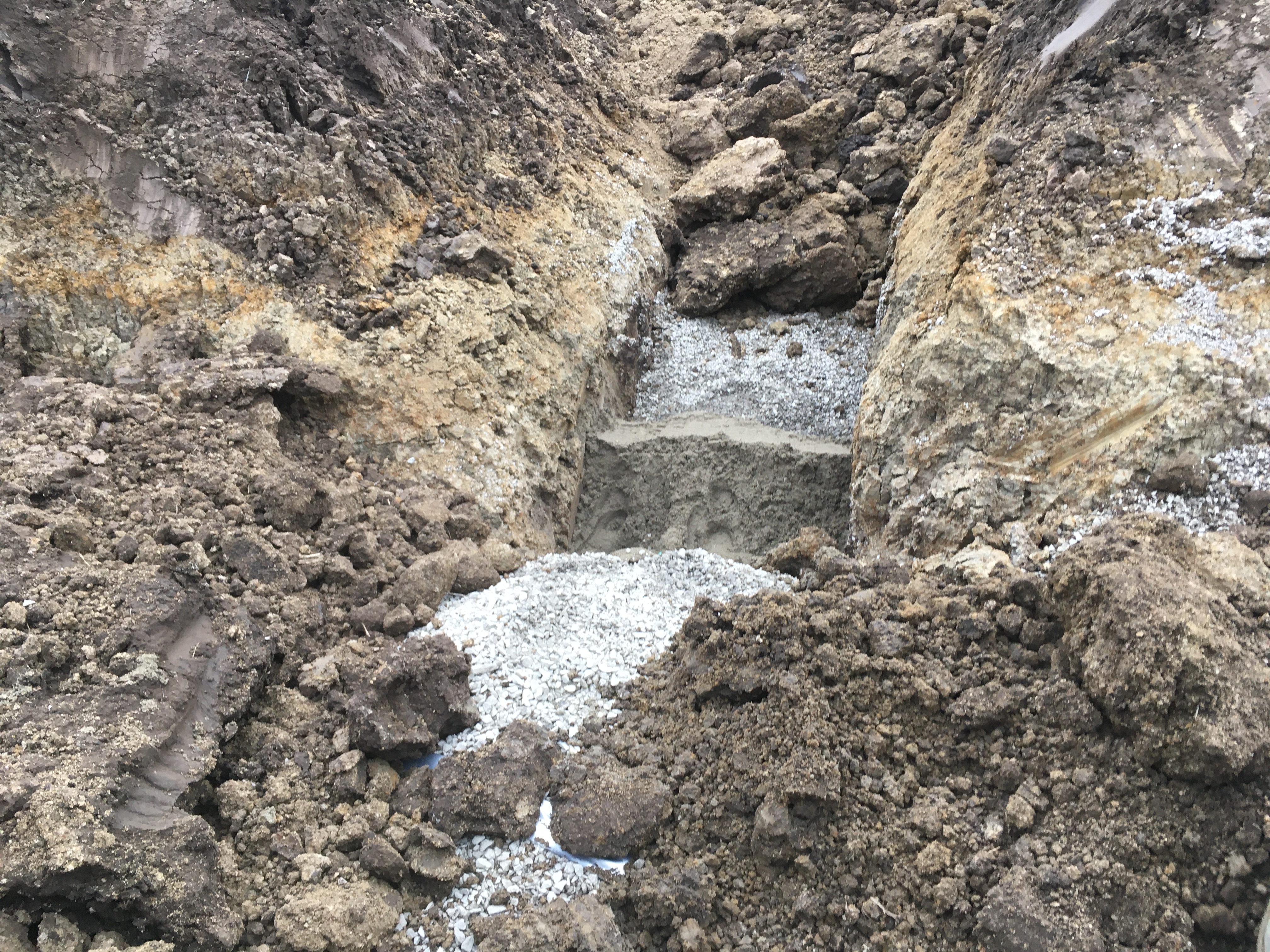

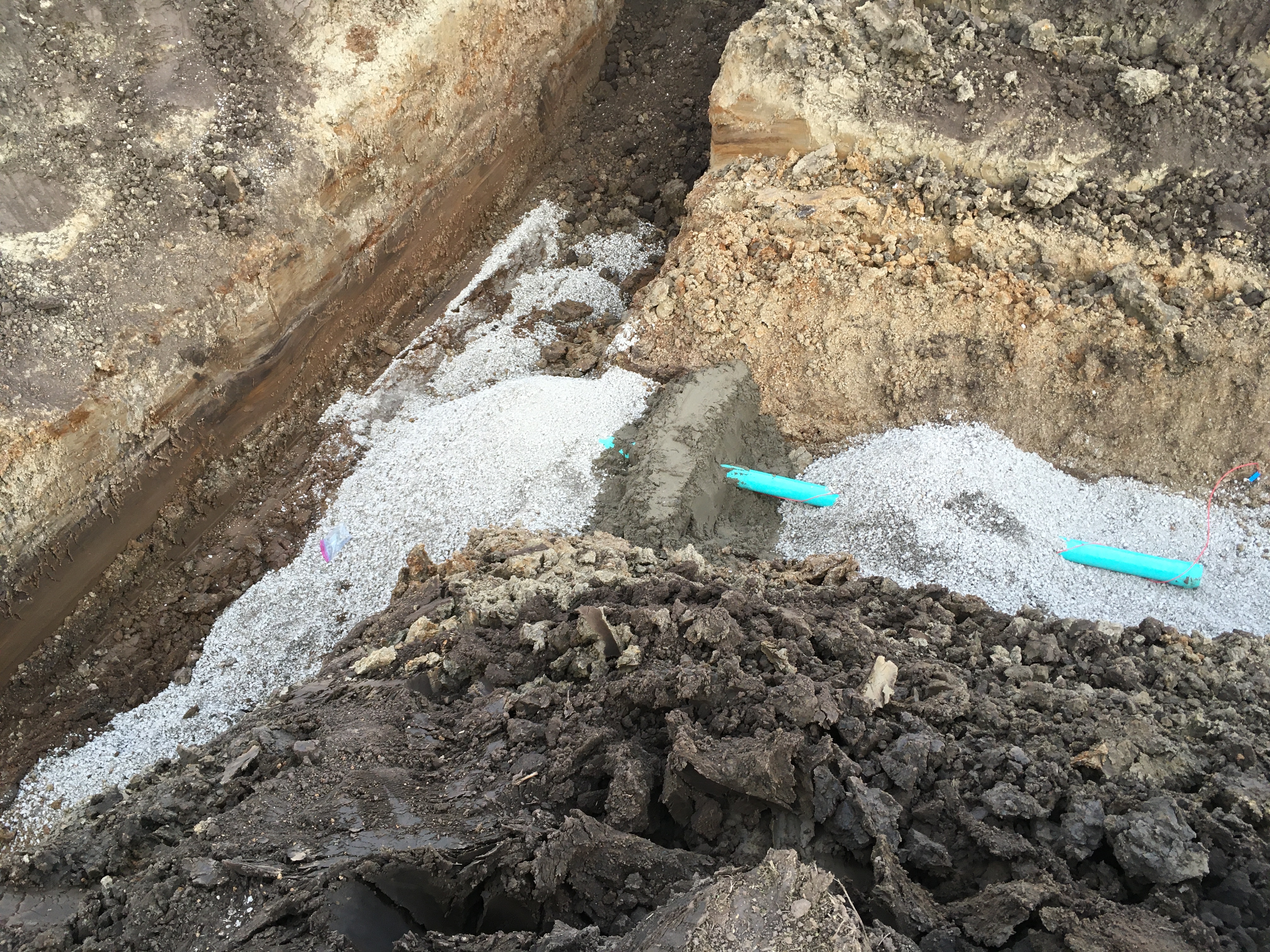

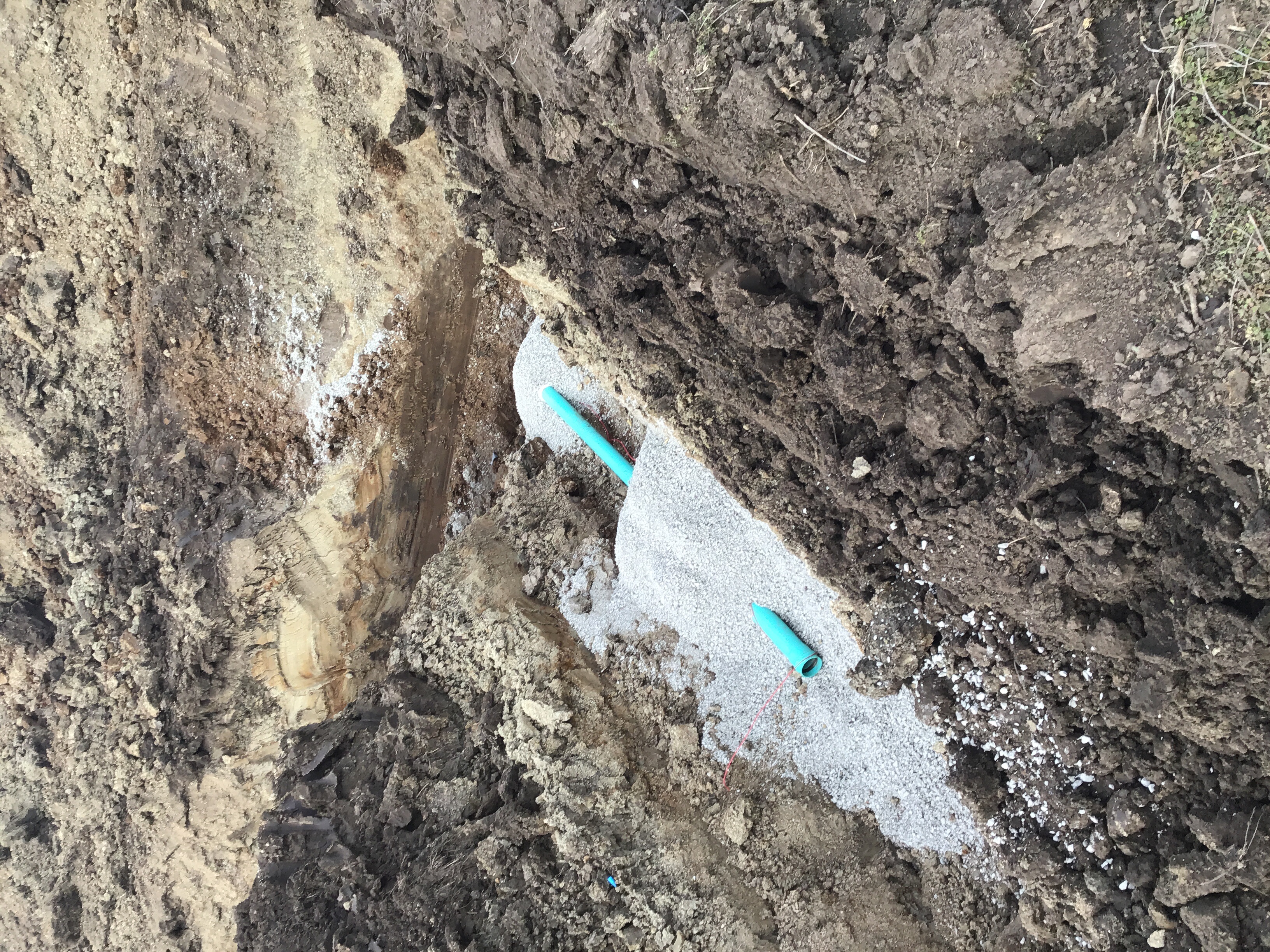

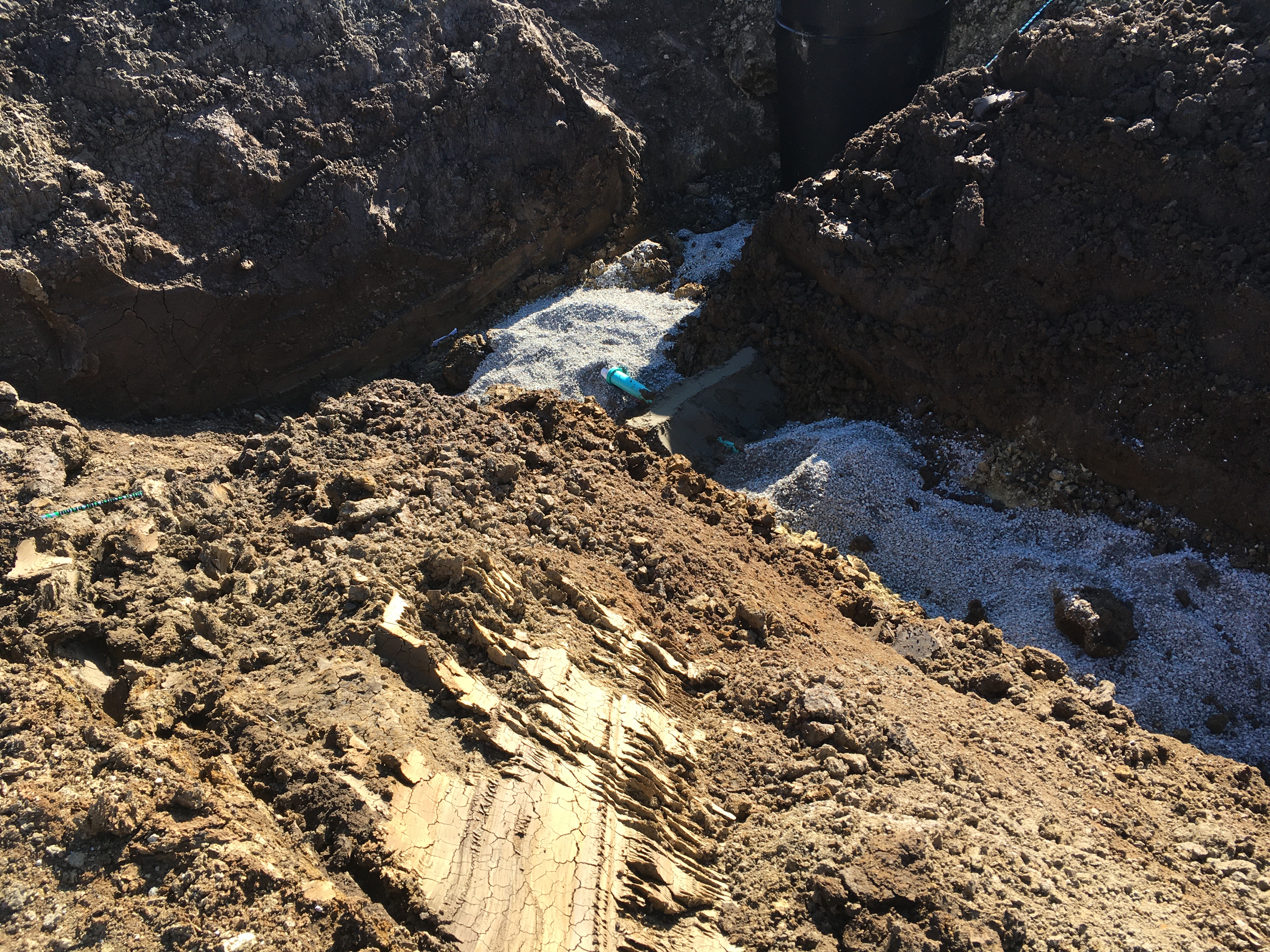

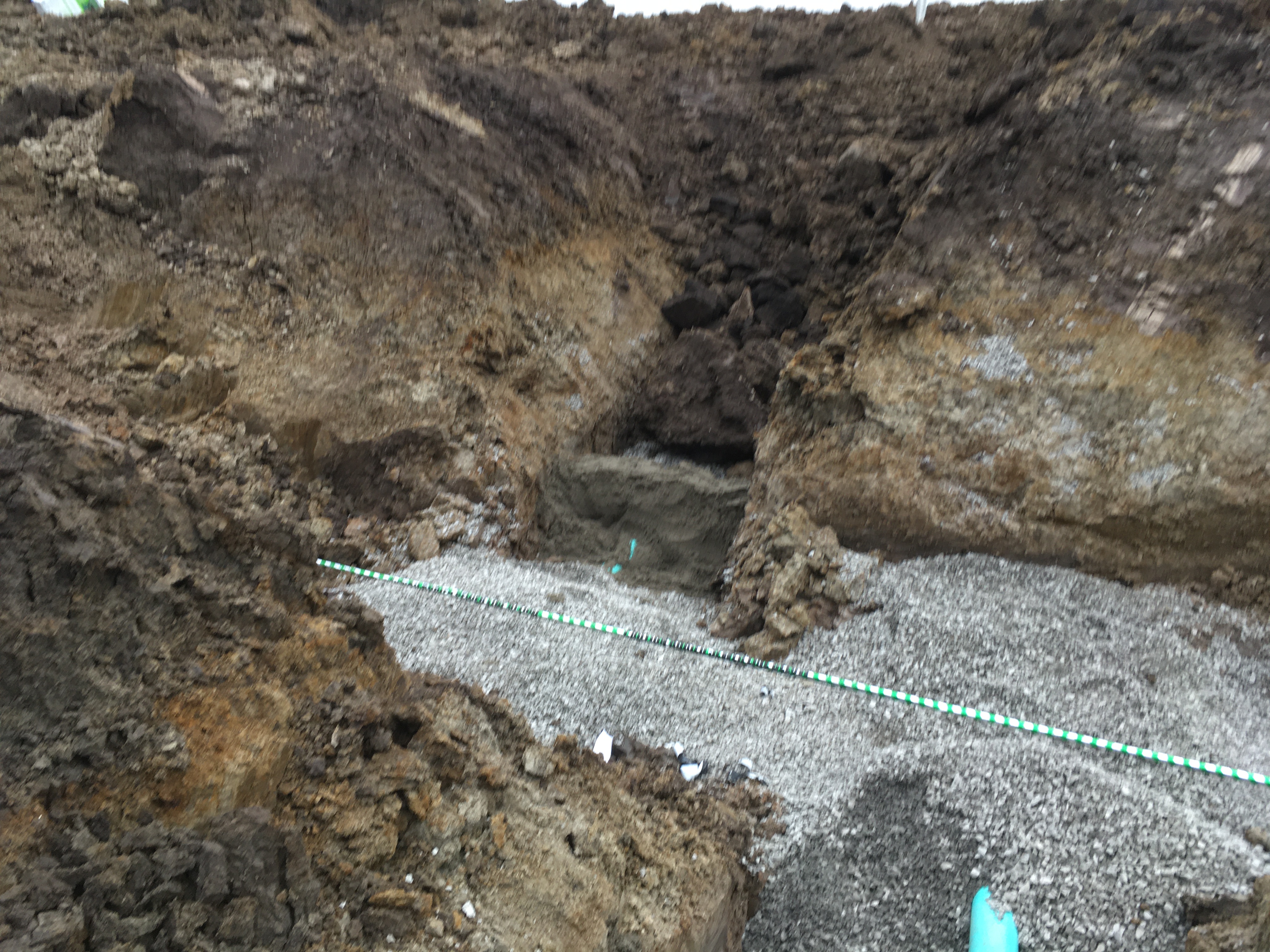

John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/03/2020
Misc
Informational
12/02/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/02/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/03/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.

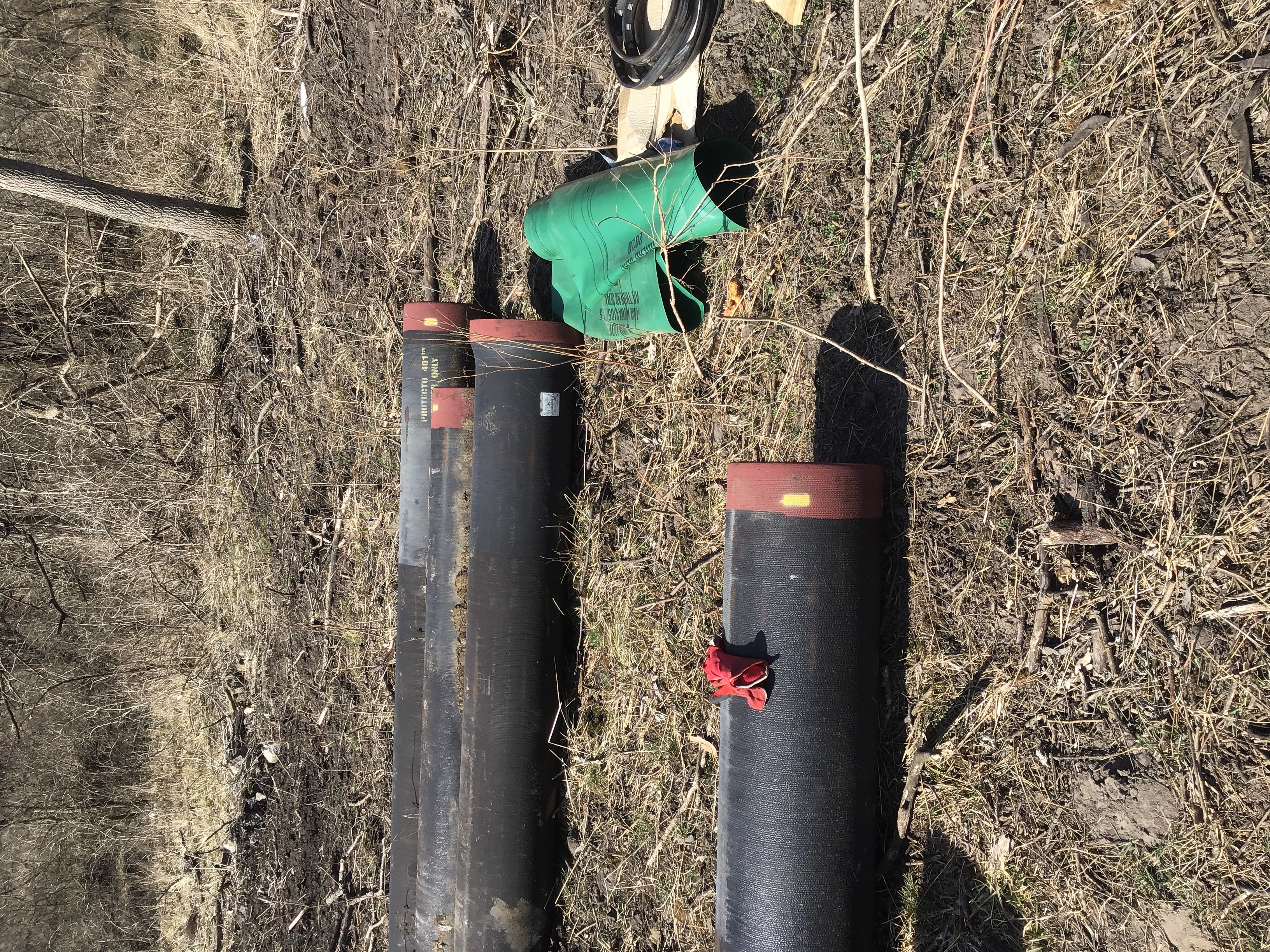

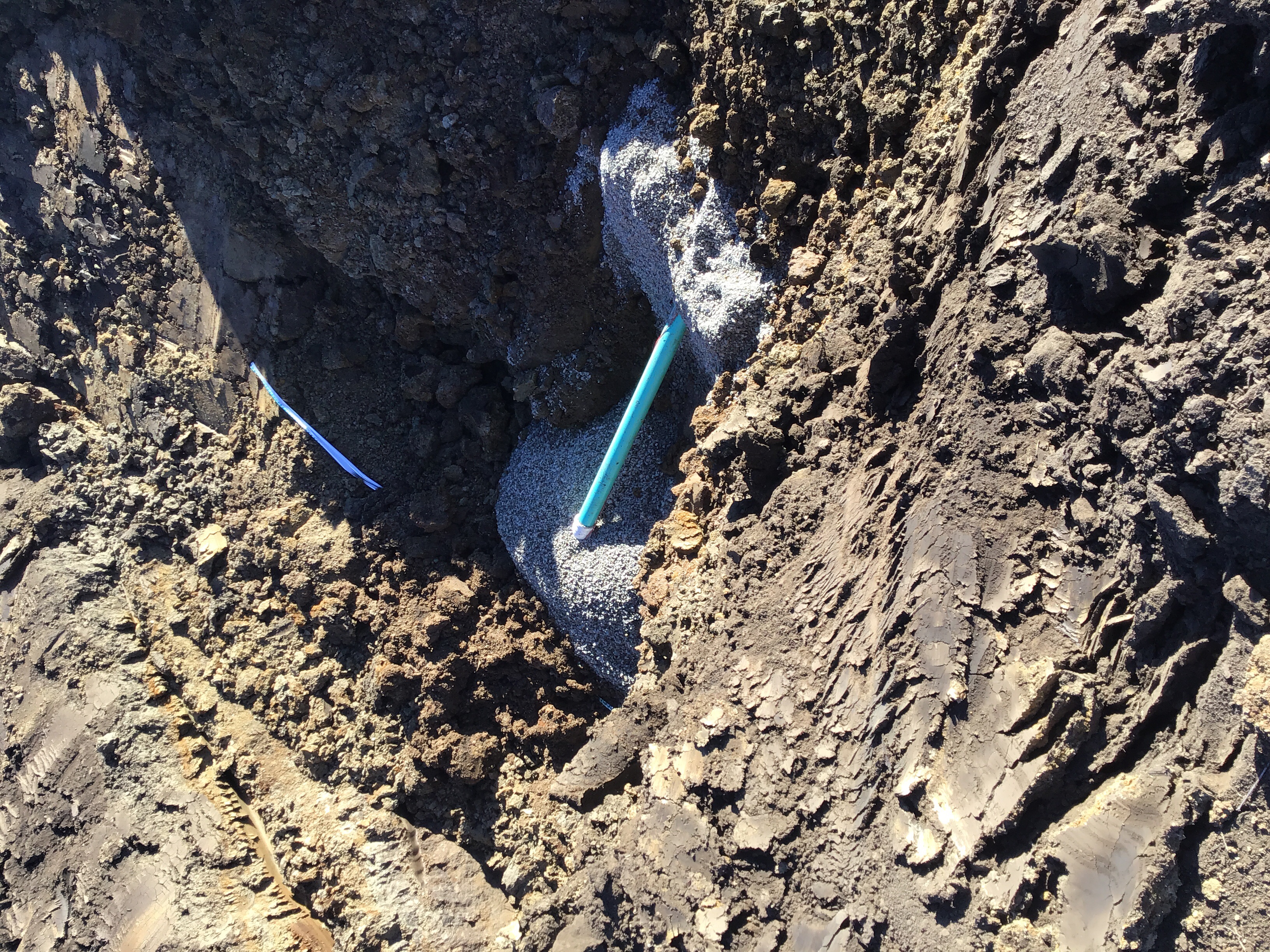

Sanitary Sewer Construction Inspection Partial 12/09/2020
Misc
Informational
12/03/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/03/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/03/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/09/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.

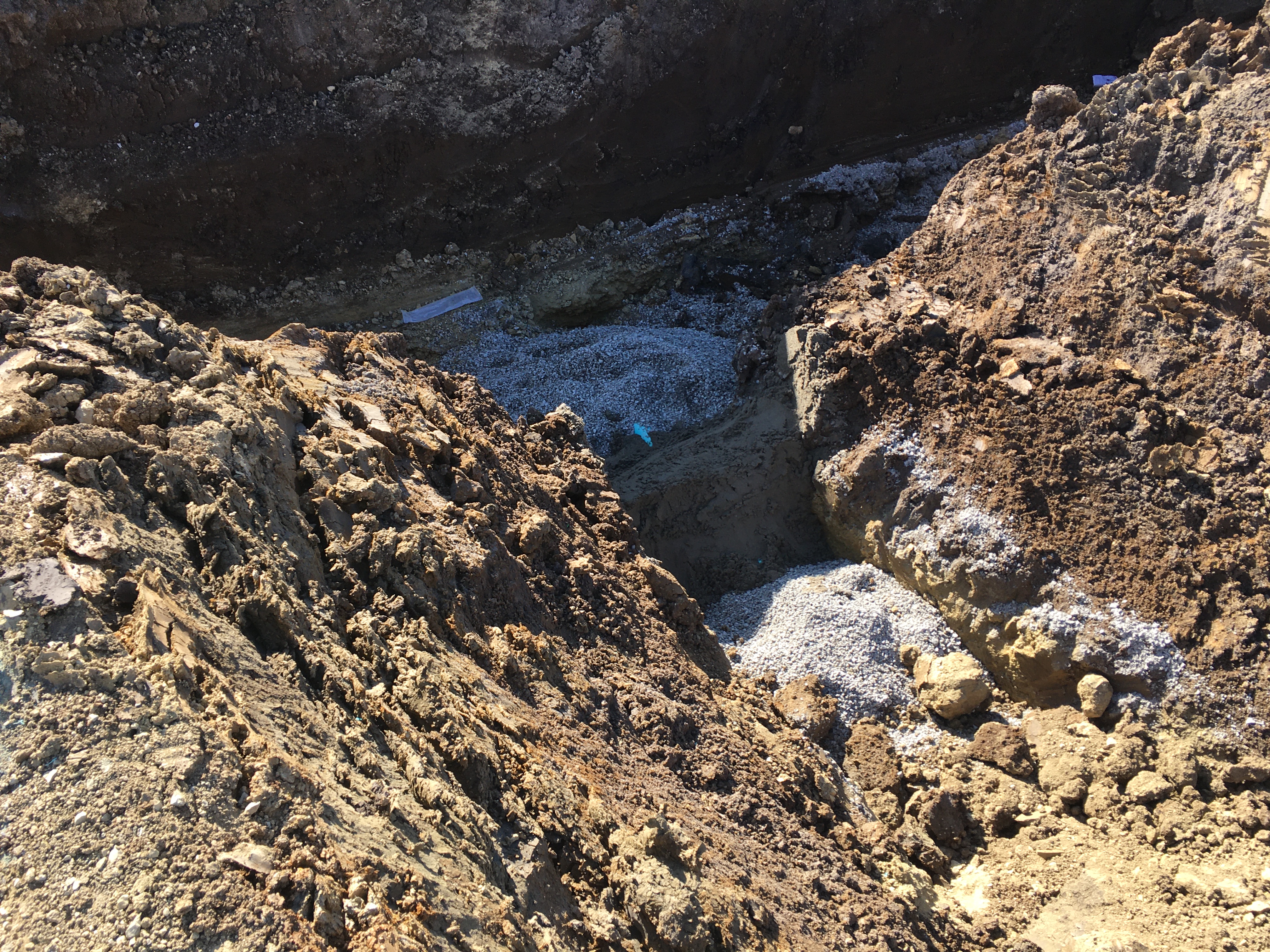

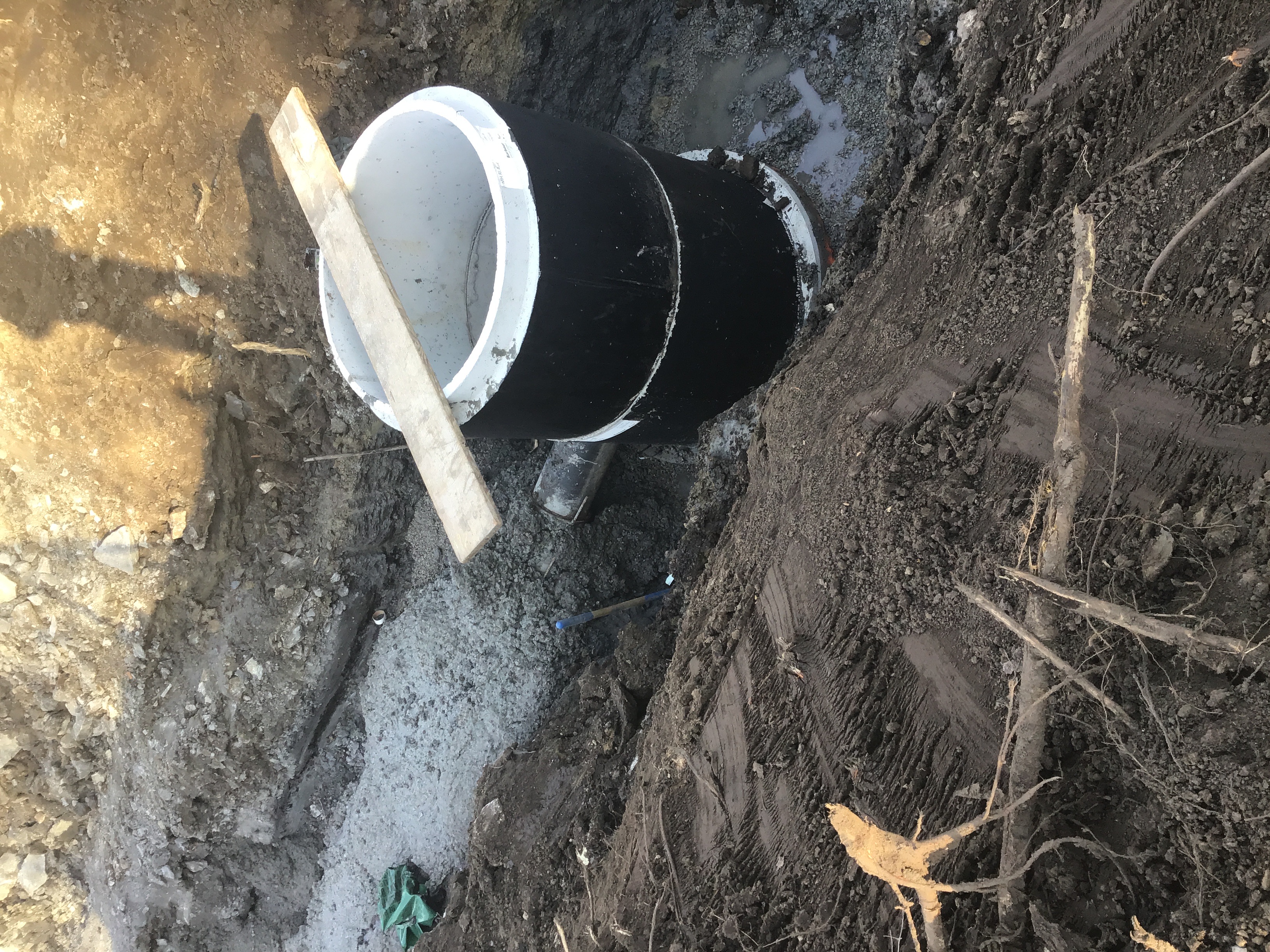

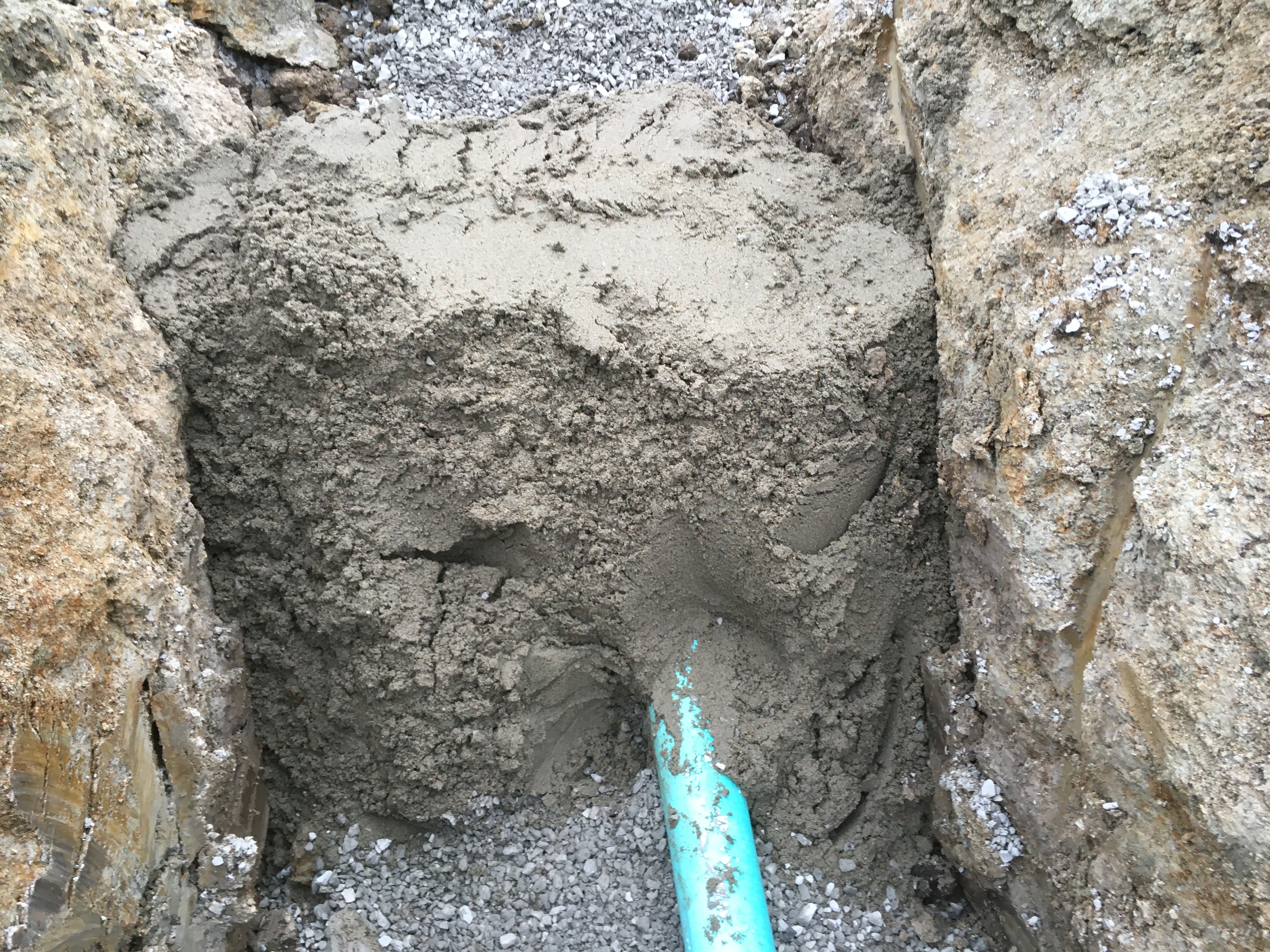

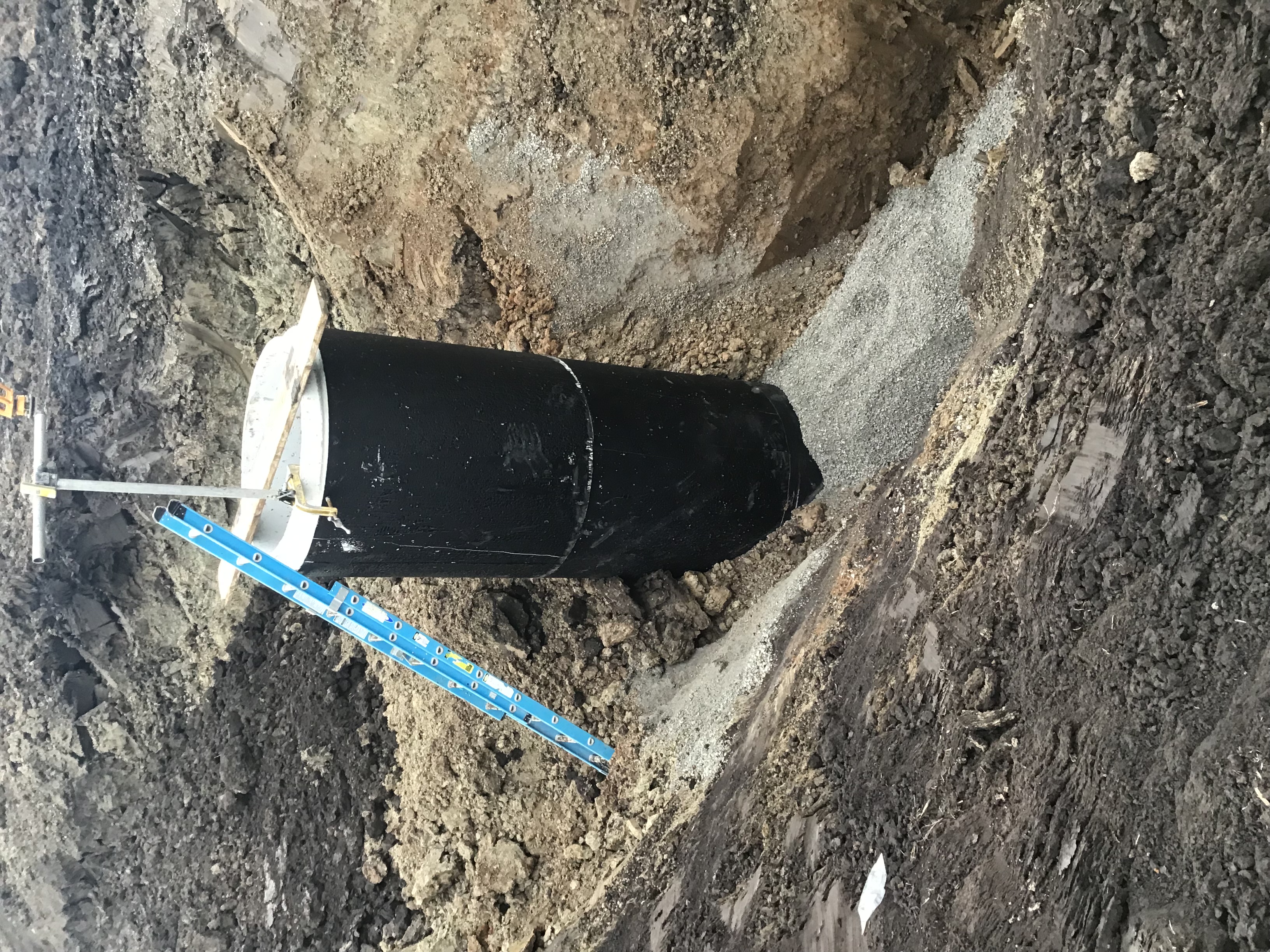

Sanitary - Material Verification Passed 12/09/2020
Misc
Informational
12/09/2020

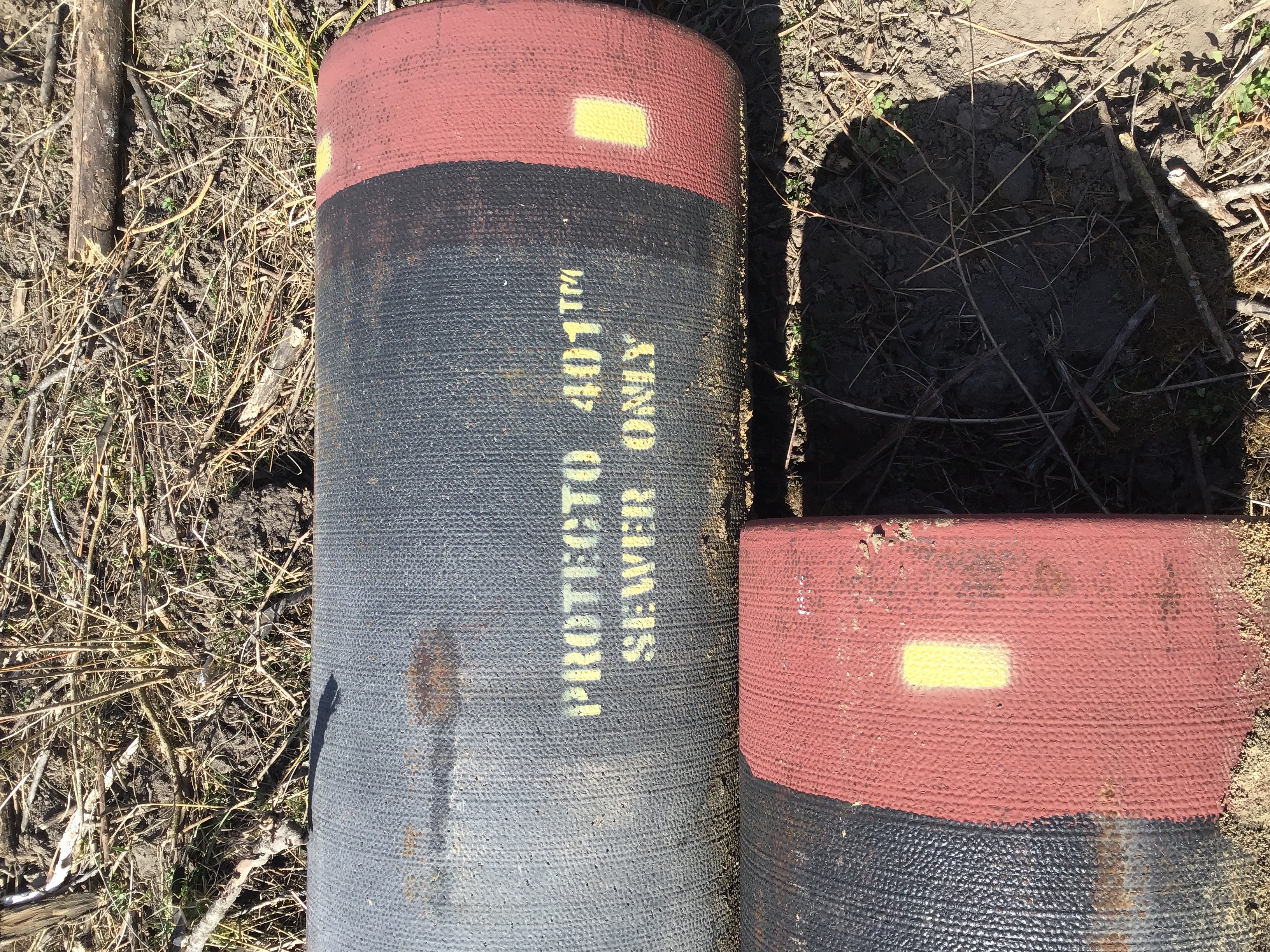

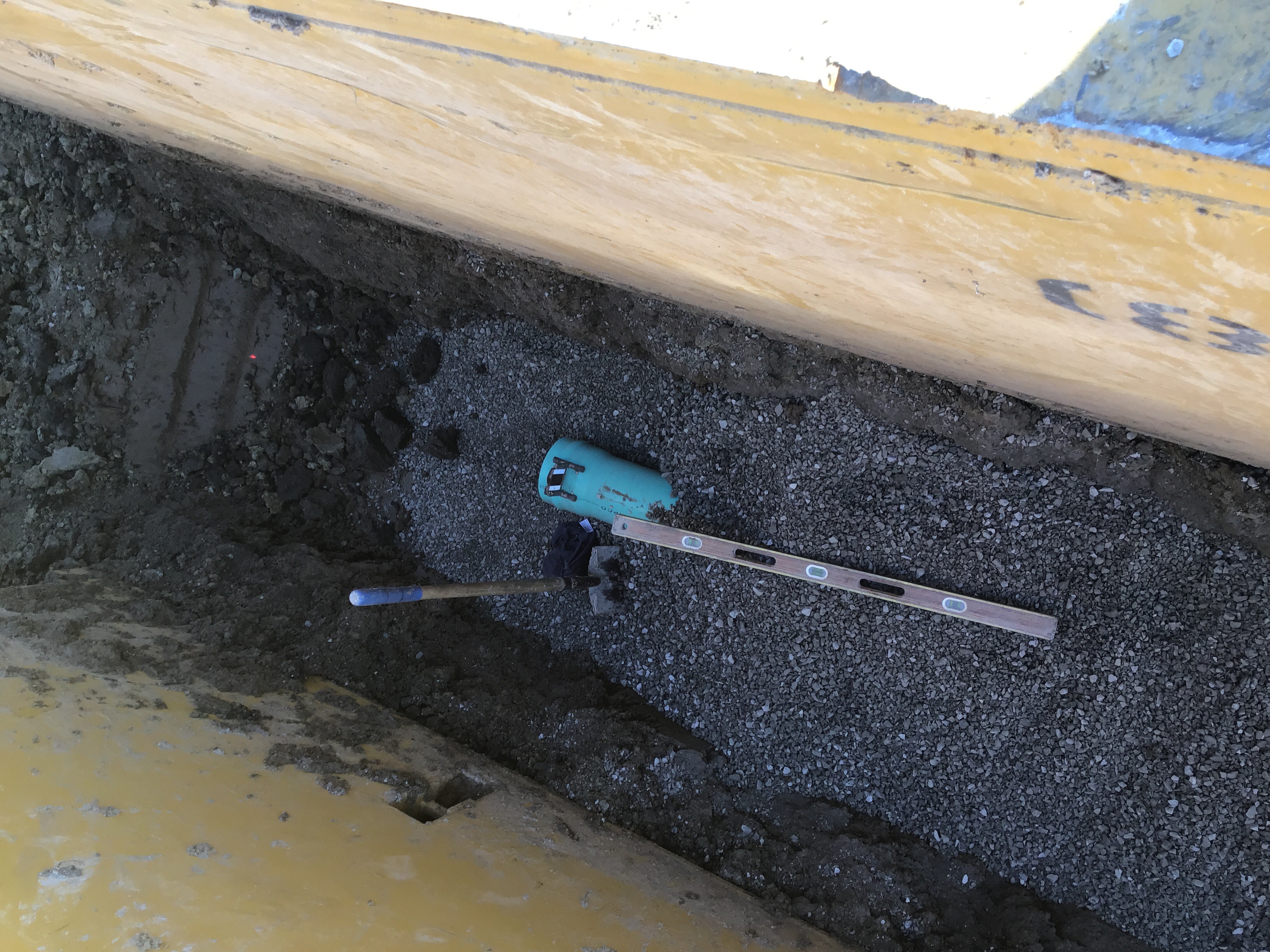

I verified that the Materials on site are in compliance with the City of LS Design and construction standards. Photos are uploaded.

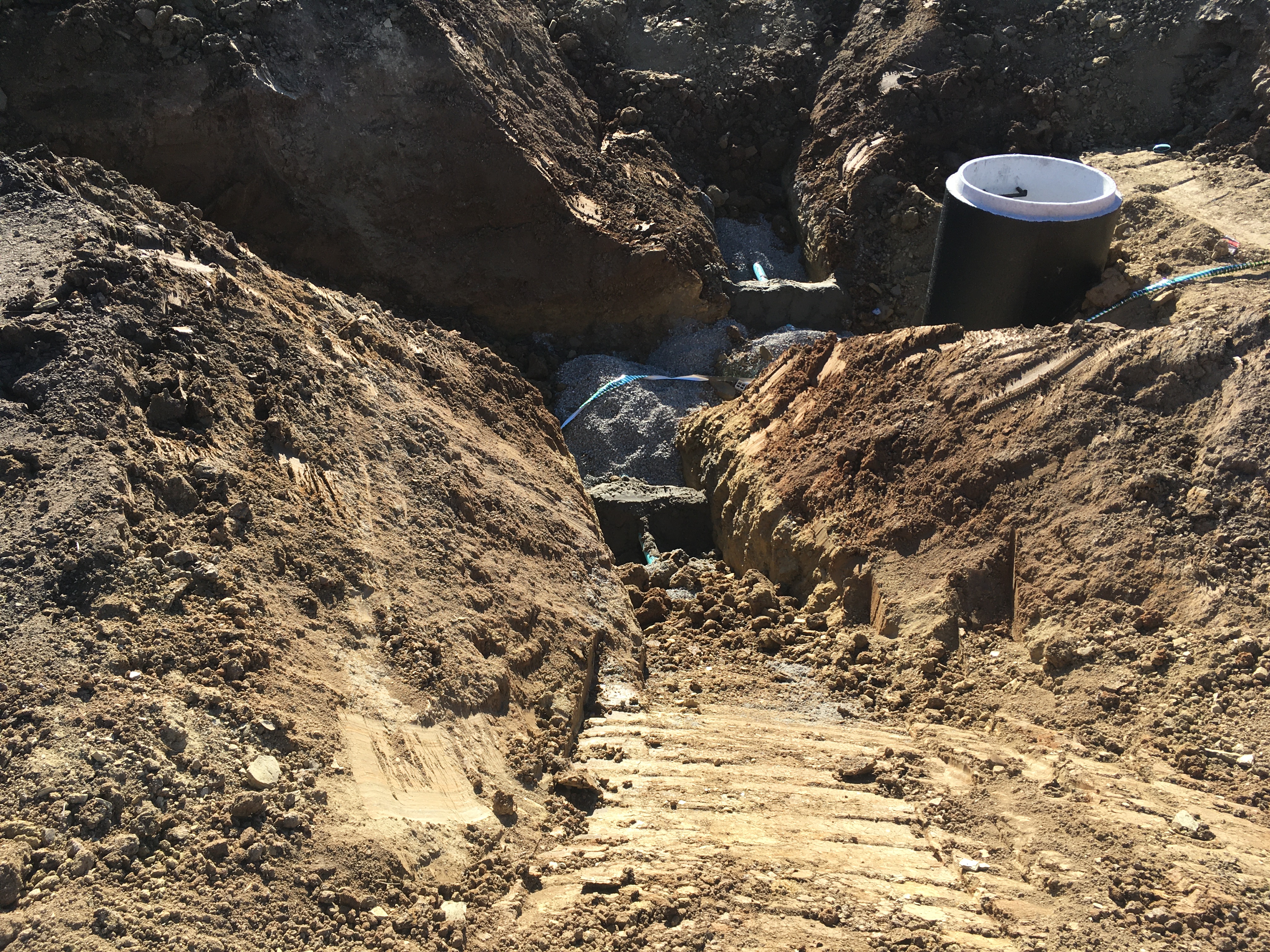

Sanitary Sewer Construction Inspection Partial 12/10/2020
Misc
Informational
12/09/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/09/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/09/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/09/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/10/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/14/2020
Misc
Informational
12/10/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/10/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/10/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/10/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/10/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/14/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/17/2020
Misc
Informational
12/14/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/14/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/14/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/14/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/14/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/14/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/15/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/17/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Sanitary Sewer Construction Inspection Partial 12/21/2020 12/21/2020 12/21/2020
Misc
Informational
12/17/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/17/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/17/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/17/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/17/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/17/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/17/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/17/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
12/21/2020
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Sanitary Sewer Construction Inspection Partial 12/22/2020
Misc
Informational
12/21/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/21/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/21/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/21/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/21/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
12/21/2020
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
12/22/2020
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Sanitary Sewer Construction Inspection Partial 12/23/2020
Misc
Informational
12/22/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/22/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/22/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/22/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/22/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
12/22/2020
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
12/22/2020
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
12/23/2020
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/28/2020
Misc
Informational
12/23/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/23/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/23/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/23/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/23/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/23/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/23/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/23/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
12/23/2020
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
12/23/2020
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
12/23/2020
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
12/28/2020
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 1/11/2021 1/11/2021 01/11/2021
Misc
Informational
12/28/2020
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
12/28/2020
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
12/28/2020
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
12/28/2020
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
12/28/2020
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
12/28/2020
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
12/28/2020
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
12/28/2020
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
12/28/2020
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
12/28/2020
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
12/28/2020
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
12/28/2020
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Sanitary Sewer Construction Inspection Partial 1/12/2021 1/12/2021 01/12/2021
Misc
Informational
01/11/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
01/11/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
01/11/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
01/11/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
01/11/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
01/11/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
01/11/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
01/11/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
01/11/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
01/11/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
01/11/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
01/11/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
01/12/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow.
Sanitary Sewer Construction Inspection Partial 1/14/2021 1/14/2021 01/14/2021
Misc
Informational
01/12/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
01/12/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
01/12/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
01/12/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
01/12/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
01/12/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
01/12/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
01/12/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
01/12/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
01/12/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
01/12/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
01/12/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
01/12/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Sanitary Sewer Construction Inspection Partial 01/21/2021
Misc
Informational
01/14/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
01/14/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
01/14/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
01/14/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
01/14/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
01/14/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
01/14/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
01/14/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
01/14/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
01/14/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
01/14/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
01/14/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
01/14/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
01/21/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 02/02/2021
Misc
Informational
01/21/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
01/21/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
01/21/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
01/21/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
01/21/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
01/21/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
01/21/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
01/21/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
01/21/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
01/21/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
01/21/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
01/21/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
01/21/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
01/21/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 2/2/21 The Redford crew is continuing the SS line 2 install today. The crew set MH 2-1 and is working on the remaining service lot stubs. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 02/03/2021
Misc
Informational
02/02/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
02/02/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
02/02/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
02/02/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
02/02/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
02/02/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
02/02/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
02/02/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
02/02/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
02/02/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Misc
Informational
02/02/2021
John DiMauro 2/2/21 The Redford crew is continuing the SS line 2 install today. The crew set MH 2-1 and is working on the remaining service lot stubs. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 2/3/2020 The Redford crew is on site working on SS line 2. The crew set service lines for lots 41 - 48 and the pool house. The trench checks are installed. Photos are uploaded.
Storm Sewer Construction Inspection Partial 03/04/2021
Misc
Informational
03/04/2021
JOHN DIMAURO 3/4/2021 The Redford crew has been working on Storm line 7 today. The crew has the line installed from the FES at station 9+93.17 to approx station 13+00. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 03/08/2021
Misc
Informational
02/03/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
02/03/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
02/03/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
02/03/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
02/03/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
02/03/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
02/03/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
02/03/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
02/03/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
02/03/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 2/2/21 The Redford crew is continuing the SS line 2 install today. The crew set MH 2-1 and is working on the remaining service lot stubs. Photos are uploaded.
Misc
Informational
02/03/2021
John DiMauro 2/3/2020 The Redford crew is on site working on SS line 2. The crew set service lines for lots 41 - 48 and the pool house. The trench checks are installed. Photos are uploaded.
Misc
Informational
03/08/2021
JOHN DIMAURO 3/8/21 The Redford crew is on site installing the SS line 1 from the existing MH 1-0 at the creek crossing. The crew has the Mh cored into and the line run across the creek at this time. The crew plans to pour the concrete encasement at 4PM. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Partial 03/09/2021
Misc
Informational
03/08/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
03/08/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
03/08/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
03/08/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
03/08/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
03/08/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
03/08/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
03/08/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
03/08/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
03/08/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 2/2/21 The Redford crew is continuing the SS line 2 install today. The crew set MH 2-1 and is working on the remaining service lot stubs. Photos are uploaded.
Misc
Informational
03/08/2021
John DiMauro 2/3/2020 The Redford crew is on site working on SS line 2. The crew set service lines for lots 41 - 48 and the pool house. The trench checks are installed. Photos are uploaded.
Misc
Informational
03/08/2021
JOHN DIMAURO 3/8/21 The Redford crew is on site installing the SS line 1 from the existing MH 1-0 at the creek crossing. The crew has the Mh cored into and the line run across the creek at this time. The crew plans to pour the concrete encasement at 4PM. Photos of the work are uploaded.
Misc
Informational
03/09/2021
John DiMauro 02/09/2021 The Redford crew installed the SS line 1 from the existing MH to MH 1-1 and encased the line in concrete. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 03/09/2021
Misc
Informational
03/09/2021
John DiMauro 11/19/2020 The Redford crew started the sanitary sewer install today. The crew set MH 1-3 and started laying to the east. The crew installed approx 150’ ft of the sewe line. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 12/02/2020 3:27 PM The Redford crew installed approx 200’ ft of the 8” SS main. The crew is set to approximately station 24+00. MH1-5 was set and service to lots 109 - 103 are installed. Flowable fill is scheduled for 3:40 to install the trench checks. Photos are uploaded.
Misc
Corrective Action Required
03/09/2021
John DiMauro 12/03/2020 3:42 PM The Redford crew has the SS line 1 run up to MH 1-6. The service lines for all the lots up to this point are installed at this time. Photos of trench checks and service lines are uploaded. The crew plans to pour inverts for Manholes 1-3, 1-4, 1-5 & 1-6 on Monday.
Misc
Informational
03/09/2021
John DiMauro 12/09/2020 10:45 AM The Redford crew is continuing the SS line 1 install. The crew installed the line from MH 1-6 to approximately station 31+00. The service laterals are installed for the lots in between. The crew plans to pour trench checks for lots this afternoon. Photos are uploaded. Olsson Testing is on site with a crew member and they are starting at the beginning of the install and getting compaction tests every 50’ ft along the line that is under the road.
Misc
Informational
03/09/2021
John DiMauro 12/10/2020 3:09 PM The Redford crew is continuing the SS line 1 install. The crew set MH 1-9 and continued to the east at this time the crew is laid up to the service for lot 26. The crew poured inverts for Manholes 1-6 & 1-7. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 12/14/2020 9:51 AM The Redford crew is continuing the SS Line 1 install today. The crew has the line installed up to approximately station 35+00. The crew plans to set MH 1-10 and then install the service lines for the previous 9 lots. They plan to pour trench checks and more inverts tomorrow. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 12/15/2020 10:35 AM The Redford crew is currently installing the service lines for lots 18 - 29. Photos are uploaded. The crew plans to pour trench checks this afternoon.
Misc
Informational
03/09/2021
John DiMauro 12/17/2020 10:30 AM The Redford crew has SS line 1 installed up to MH 1-11. The crew set MH 1-11 and stacked it this morning. The crew plans to pour inverts for MH 1-10 & 1-9 today as well as trench checks for the remaining service lines.
Misc
Informational
03/09/2021
John Jackson 12/21/2020 2:40 PM The Redford crew has SS line 1 installed 8” SDR-26 from MH 1-11 to MH1-12 which was installed today. Approximately 130’ of sanitary main and service lines were installed. Contractor continued to install service lines on SS line 1.
Misc
Informational
03/09/2021
John Jackson 12/22/2020 10:20 PM Olsson performed compaction test on road crossing. Contractor backfilled excavation.
Misc
Informational
03/09/2021
John DiMauro 12/23/2020 The Redford crew is working on the SS install. The crew installed SS line 2 up to MH 2-2. The crew plans to start on line 2 service laterals next Monday. The crew also poured inverts for SS MH’s 1-11 & 1-12. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 12/28/2020 11:00 AM The REdford crew is continuing the SS line 2 install. The crew is setting the service lines for lots 14, 15, & 34-38. Photos are uploaded. 1-11-21 3:04pm They have manhole 2-1 in and ran sanitary line to 3-1. They have plenty of rock.
Misc
Informational
03/09/2021
1-12-21 2:31pm Joe Starlin They are working on 6 service lines and will be using flowable fill tomorrow. They will be working on line 2 tomorrow. 1-14-21 3:50pm They have installed approximately 84’ out of manhole 2-2. They have approximately 60’ of service lines installed. They are working through rock at this time.
Misc
Informational
03/09/2021
John DiMauro 01/21/2021 The Redford Construction crew is continuing the SS Line 2 install. The crew poured inverts for manholes 2-1 & 2-1. The crew has MH 2-3 set and is installing the service lines for lots 1, 38, 39, 40 & 41. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 2/2/21 The Redford crew is continuing the SS line 2 install today. The crew set MH 2-1 and is working on the remaining service lot stubs. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 2/3/2020 The Redford crew is on site working on SS line 2. The crew set service lines for lots 41 - 48 and the pool house. The trench checks are installed. Photos are uploaded.
Misc
Informational
03/09/2021
JOHN DIMAURO 3/8/21 The Redford crew is on site installing the SS line 1 from the existing MH 1-0 at the creek crossing. The crew has the Mh cored into and the line run across the creek at this time. The crew plans to pour the concrete encasement at 4PM. Photos of the work are uploaded.
Misc
Informational
03/09/2021
John DiMauro 02/09/2021 The Redford crew installed the SS line 1 from the existing MH to MH 1-1 and encased the line in concrete. Photos are uploaded.
Misc
Informational
03/09/2021
John DiMauro 3/9/21 The Redford crew set MH 1-1 and continued the line 1 run. The crew set approx 70’ ft of the line before running into soil condition issues. Redford consulted with the engineer and compaction testing company about the next steps to take prior to continuing the install.
Storm Sewer Construction Inspection Partial 03/30/2021
Misc
Resolved
03/30/2021
JOHN DIMAURO 3/4/2021 The Redford crew has been working on Storm line 7 today. The crew has the line installed from the FES at station 9+93.17 to approx station 13+00. Photos are uploaded.
Misc
Informational
03/30/2021
The Redford crew is wrapping up the storm sewer install. The crew has the lines complete and is setting lids for the boxes. The collars have been poured and he crew plans to pour the final inverts this week. Photos of the work are uploaded.
Sanitary Sewer - Air Test Partial 04/02/2021
Misc
Informational
04/02/2021
John DiMauro I observed the psi test for the majority of line1 and all of lines 2 & 3. Lines 2 & 3 passed psi testing. Line 1 from MH 1-3 to the end of line passed. All testing is still required on line 1 from Existing MH to MH 1-3
Sanitary Sewer - Vacuum Partial 04/02/2021
Misc
Informational
04/02/2021
John DiMauro I observed the vacuum testing for SS lines 1, 2 & 3. Line 1: Manholes 1-3 through 1-12 passed. Manholes 1-1 & 1-2 still need tested. Line 2: All manholes passed except 2-3. Crew made corrections and plans to teat again in the future. Line 3: passed.
Sanitary Sewer - Mandrel Partial 4/6/2021 04/06/2021
Misc
Informational
04/06/2021
We used a 7.37 inch mandrel for the 8 inch sanitary lines. That was manholes 1-5, 1-6, 1-7, 1-8, 1-9, 1-10, 1-11, 1-12, 2-1, 2-2, 2-3, 2-4, 3-1 and 3-2. Still need to mandrel the 12 inch sanitary lines RP 4-6-21
Sanitary Sewer - Vacuum Failed 4/6/2021 04/06/2021
Misc
Informational
04/02/2021
John DiMauro I observed the vacuum testing for SS lines 1, 2 & 3. Line 1: Manholes 1-3 through 1-12 passed. Manholes 1-1 & 1-2 still need tested. Line 2: All manholes passed except 2-3. Crew made corrections and plans to teat again in the future. Line 3: passed.
Misc
Corrective Action Required
04/06/2021
Redford replaced a cracked 6 inch ring and resealed manhole 2-3. Still couldn’t hold 10 pounds of vacuum for 2 1/2 minutes. They are going to try to find the leak and retest another day. RP 4-6-21
Public Curb Inspection Passed 04/27/2021
Misc
Informational
05/12/2021
On Wednesday Spalding Excavation completed a Curb Proof Roll that passed sub grade compaction and is ready for curb installation.
Pavement-Proof Roll Passed 05/06/2021
Misc
Informational
05/06/2021
On Wednesday, 5-05-2021. Contractor performed proof roll for sub base. Found small areas where sub grade needed to be removed and replaced with additional rock fill. Proof Roll passed for rock base to be placed.
Misc
Informational
05/06/2021
On Thursday, 5-06-2021. Contractor (Spalding) Placed type 5 aggregate base and compacted.
Site Visit Partial 06/12/2021
Misc
Informational
06/12/2021
On Friday, 6-11-2021. Superior Bowen asphalt layer 800 to of type 5 recycle base asphalt until the plant broke down at 11:30. they resumed at 1:30 till 3:30. Heavy rains stop any more overlays. On Saturday, 6-12-2021. Contractor resumed asphalt overlay. Contractor placed approx 1,100 ton of base asphalt. Sub grade proof would not allow us to place asphalt because entrance was to wet to lay. On Monday, 7-19-2021 Red Ford Excavating worked completing punchlist item identified earlier.
Street - Surface Course Passed 06/14/2021
Misc
Informational
06/14/2021
On Monday, 6-14-2021. Superior/Bowen layer the surface asphalt for the project. KC Testing there to provide the compaction testing.
Water Line - Fire Hydrant Partial 06/23/2021
Misc
Informational
06/23/2021
On Wednesday, 6-23-2021. Contractor installed hydrant on line #1 @sta.15+18 On Wednesday, 7-07-2021. Red Ford installed hydrant on line #4 at sta 19+81 On Tuesday, 7-12-2021. Redford Excavating resumed installation of the 8” water line. Contractor completed line #4 and installed last hydrant on line 4. Contractor backfilled pipe. Contractor also worked preparing for water line ‘T‘ installation for watermain. Contractor put together Valve, sleeves and pipe.
Water Line - Thrust Restraint Passed 07/15/2021
Misc
Informational
07/09/2021
On Thursday, 7-08-2021. Redford Excavating poured restraints for prior waterline fittings and hydrant installations. On Monday, 7-12-2021. Redford poured thrust restraints for fittings from sta 17+00 through the end of line #4. On Wednesday, 7-14-2021, Redford Excavating poured Thrust restraints for 16” ‘T’ for water main connection performed and also trust blocks for water line #4 at bends installed day before. On Tuesday, 8-03-2021. Red Ford excavating pour thrust block restraint for 16”north tap location for . main
Water Line - Coliform Test 2 Passed 08/02/2021
Misc
Informational
08/02/2021
On Thursday, 7-29-2021. Red Ford Excavating provided a (2nd) water sample for testing for the domestic line. On Friday, 7-30-2021. A passing result was given by Keystone Lab for the water 2nd sample given on Thursday
Misc
Informational
08/02/2021
On Thursday, 7-29-2021. Red Ford Excavating provided a (2nd) water sample for testing for the domestic line. On Friday, 7-30-2021. A passing result was given by Keystone Lab for the water 2nd sample given on Thursday
Water Line - Coliform Test 1 Partial 08/03/2021
Misc
Informational
07/30/2021
On Wednesday, 7-29-2021. Red Ford Excavating provided me with a water sample for the domestic line. Sample was taken to the Keystone lab for testing.
Misc
Informational
07/30/2021
On Thursday, 7-29-2021. A 2nd water sample was taken to the lab for testing. The first sample passed testing. Got results back late afternoon.
Misc
Informational
08/02/2021
On Thursday, 7-29-2021. A 2nd water sample was taken to the lab for testing. The first sample passed testing. Got results back late afternoon. On Thursday, 7-29-2021, The (1st) sample given by Keystone showed up late afternoon and passed testing
Misc
Informational
08/02/2021
On Thursday, 7-29-2021. A 2nd water sample was taken to the lab for testing. The first sample passed testing. Got results back late afternoon. On Thursday, 7-29-2021, The (1st) sample given by Keystone showed up late afternoon and passed testing
Misc
Informational
08/03/2021
On Thursday, 7-29-2021. A 2nd water sample was taken to the lab for testing. The first sample passed testing. Got results back late afternoon. On Thursday, 7-29-2021, The (1st) sample given by Keystone showed up late afternoon and passed testing
Misc
Informational
08/03/2021
On Monday, 8-02-2021. Red Ford Excavating back field tap #1 North side of project and dug pit for South tap for water main connection for tomorrow’s.
Water Line - Hydrostatic Test Passed 08/03/2021
Misc
Informational
08/03/2021
On Monday, 7-26-2021. Red Ford Excavating Completed a Hydrostatic Pressure test and passed the 2 hr 150 lbs pressure time limit, passing test.
Water Line - Construction Taps Removed Passed 08/03/2021
Misc
Informational
08/03/2021
On Monday, 8-02-2021. Red Ford Excavating remove the corp placed by water Services and backfilled.
Water Line - Construction Inspection Passed 08/03/2021
Misc
Informational
06/23/2021
On Wednesday, 6-23-2021. Redford construction installed 8” water line on line #6. (1) hydrant was installed as well. On Wednesday. 7-07-2021. Red Ford Excavating resumed 8” waterline installation. Contractor installed waterline from 15+53 to 20+21 placing all fittings bends and backfilling all pipe. On Thursday, 7-08-2021. Contractor resumed waterline installation. Picking up at sta 20+21 contractor continued to install 8” waterlines w/ fittings. Backfilled pipe where app. Poured restraints for today bends and yesterdays as well. On Friday Redford Excavating resumed 8” Waterline installation. Contractor started at sta 12+00 moving backwards on baseline approx. 240 LF installing all fittings including 8x8 tee for line #4. On Monday, Redford excavating resumed waterline installation. Contractor installed remaining portion of line #4 including fire hydrant. Contractor completing remaining leg work for watermain tap for Wednesday. On Tuesday, 8-03-2021. Red Ford Excavating performed the last main “T” tap for the north side of the project. Main tap started at 7:30 am and was completed at 12:00 pm.
Erosion Control Inspection Failed 02/08/2022
Misc
Informational
02/08/2022
Erosion control failed. Fencing has fallen over and mud is being tracked into Pryor Road.
Sidewalk Inspection Partial 08/22/2022
Misc
Informational
08/22/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance.
Sidewalk Inspection Partial 08/22/2022
Misc
Informational
08/22/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance. Sidewalk was formed up and aggregate was placed and compacted.
Sidewalk Inspection Partial 08/22/2022
Misc
Informational
08/22/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance. Sidewalk was formed up and aggregate was placed and compacted. Concrete then was poured for sidewalk.
Sidewalk Inspection Partial 08/25/2022
Misc
Informational
08/22/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance. Sidewalk was formed up and aggregate was placed and compacted. Concrete then was poured for sidewalk. 8-25-22 RH. Sidewalk pour is being completed tomorrow at the intersection of Farmfield and 26th Terrac.
Sidewalk Inspection Partial 08/26/2022
Misc
Informational
08/25/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance. Sidewalk was formed up and aggregate was placed and compacted. Concrete then was poured for sidewalk. 8-25-22 RH. Sidewalk pour is being completed tomorrow at the intersection of Farmfield and 26th Terrace 8-26-22 RH. Sidewalk was finished at the corner of Farmfield and 26th Terrace.
Sidewalk Inspection Passed 08/30/2022
Misc
Informational
08/26/2022
8-22-22 RH. Sidewalk started being formed up at entrance to site just past community pool entrance. Sidewalk was formed up and aggregate was placed and compacted. Concrete then was poured for sidewalk. 8-25-22 RH. Sidewalk pour is being completed tomorrow at the intersection of Farmfield and 26th Terrace 8-26-22 RH. Sidewalk was finished at the corner of Farmfield and 26th Terrace. 8-30-22 RH. Sidewalk meets LS and ADA Specification.
Documents & Images
Date Uploaded File Type Document Name
07/01/2020 Hook Farms 20-06-29_Site_Disturbance Approved 7.1.20
09/10/2020 Receipt Receipt for transaction:2020-006123
09/15/2020 Plans Hook Farms 1st Plat Street & Storm Approved 9.15.20
09/15/2020 Approved Plans Hook Farms 1st plat Sanitary Sewer Approved 9.15.20
09/15/2020 Approved Plans Hook Farms, 1st plat Water Main Plans Approved 9.15.20
10/07/2020 Approved Plans Hook Farms, 1st Plat - Water revision Approved 10.7.20
10/13/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 A-6 Sediment basin.jpg
10/22/2020 Spillway Riser & Skimmer.jpg
11/19/2020 SS line 1.jpg
11/19/2020 Letter INSPECTION SUMMARY
12/01/2020 Letter INSPECTION SUMMARY
12/01/2020 SS Lot 109 Lateral and trench check.jpeg
12/01/2020 SS lot 109 Lateral and check.jpeg
12/01/2020 SS lateral 110 install.jpeg
12/01/2020 SS 110 lateral install.jpeg
12/02/2020 SS line 1 install.jpg
12/02/2020 SS lot 103 lateral.jpg
12/02/2020 SS lot 104 Lateral .jpg
12/02/2020 SS lot 105 Lateral .jpg
12/02/2020 SS MH 1-5 set.jpg
12/02/2020 Letter INSPECTION SUMMARY
12/03/2020 Trench check 103.jpeg
12/03/2020 Trench check 104.jpeg
12/03/2020 Trench check 105.jpeg
12/03/2020 Trench check 106.jpeg
12/03/2020 Trench check l07.jpeg
12/03/2020 Trench check 108.jpeg
12/03/2020 SS MH 1-6.jpeg
12/03/2020 Letter INSPECTION SUMMARY
12/08/2020 Plans obsolete Hook Farms 1st Plat Revised Street & Storm Approved 12.8.20
12/09/2020 SS line 1.jpg0
12/09/2020 SS MH 1-8.jpg
12/09/2020 MH 1-8 SS.jpg
12/09/2020 SS mh 1-7.jpg
12/09/2020 SS mh 1-7.jpg0
12/09/2020 SS lot 100.jpg
12/09/2020 SS lot 30.jpg
12/09/2020 SS lot 32.jpg
12/09/2020 SS lot 15.jpg
12/09/2020 SS lot 31.jpg
12/09/2020 SS lot 16.jpg
12/09/2020 SS lot 33.jpg
12/09/2020 SS main line 1.jpg
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/10/2020 SS line 1 install.jpg0
12/10/2020 SS line 1 install.jpg1
12/10/2020 SS MH -9.jpg
12/10/2020 Letter INSPECTION SUMMARY
12/14/2020 Letter INSPECTION SUMMARY
12/16/2020 TRENCH CHECK 102.jpeg
12/16/2020 TRENCH CHECK 101.jpeg
12/16/2020 TRENCH CHECK 100.jpeg
12/16/2020 TRENCH CHECK 33.jpeg
12/16/2020 TRENCH CHECK 32.jpeg
12/16/2020 TRENCH CHECK 15.jpeg
12/16/2020 TRENCH CHECK 31.jpeg
12/16/2020 TRENCH CHECK 16.jpeg
12/16/2020 TRENCH CHECK 30.jpeg
12/16/2020 TRENCH CHECK 17.jpeg
12/16/2020 TRENCH CHECK 29.jpeg
12/16/2020 TRENCH CHECK 18.jpeg
12/16/2020 TRENCH CHECK 28.jpeg
12/16/2020 TRENCH CHECK 19.jpeg
12/16/2020 TRENCH CHECK 27.jpeg
12/16/2020 TRENCH CHECK 20.jpeg
12/16/2020 TRENCH CHECK 26.jpeg
12/16/2020 TRENCH CHECK 25.jpeg
12/17/2020 SS MH 1-11.jpg
12/17/2020 SS Line 1.jpg1
12/17/2020 SS line Install .jpg
12/17/2020 Letter INSPECTION SUMMARY
12/21/2020 Letter INSPECTION SUMMARY
12/22/2020 Letter INSPECTION SUMMARY
12/23/2020 Letter INSPECTION SUMMARY
12/28/2020 SS MH 2-1 set.jpg
12/28/2020 Letter INSPECTION SUMMARY
01/11/2021 Letter INSPECTION SUMMARY
01/12/2021 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
01/21/2021 Letter INSPECTION SUMMARY
01/21/2021 SS LINE 2.jpeg
01/21/2021 SS LINE 2.jpeg0
01/21/2021 SS LINE 2.jpeg1
01/21/2021 SS LINE 2.jpeg2
01/21/2021 SS LINE 2.jpeg3
01/21/2021 SS LINE 2.jpeg4
01/21/2021 SS LINE 2.jpeg5
01/21/2021 SS LINE 2.jpeg6
01/21/2021 SS LINE 2.jpeg7
01/21/2021 SS LINE 2.jpeg8
01/21/2021 SS LINE 2.jpeg9
01/21/2021 SS LINE 2.jpeg10
01/21/2021 SS LINE 2.jpeg11
01/21/2021 SS LINE 2.jpeg12
01/21/2021 SS LINE 2.jpeg13
01/21/2021 SS LINE 2.jpeg14
02/02/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 0A2FCBDE-B8E5-4AB5-9338-D3C5F62EBE33.jpeg
02/03/2021 25DB311C-3A08-446F-B6AF-4A7AD5E57BE8.jpeg
02/03/2021 93ED40B2-FB15-4E32-A3CD-D6DBF5F5C93E.jpeg
02/03/2021 A87E7DA6-7DFD-4348-AE97-750919CC87BA.jpeg
02/03/2021 97963C9F-B58F-49BF-8C3F-BAD12D69267B.jpeg
02/03/2021 1C7A5157-E122-4B56-8E3C-1FB29804441A.jpeg
02/03/2021 A7A9ED44-0768-4547-A400-DDA2CB21AAEE.jpeg
02/03/2021 865AA138-C44C-40C3-96D4-3BD8B177ABDC.jpeg
03/04/2021 Letter INSPECTION SUMMARY

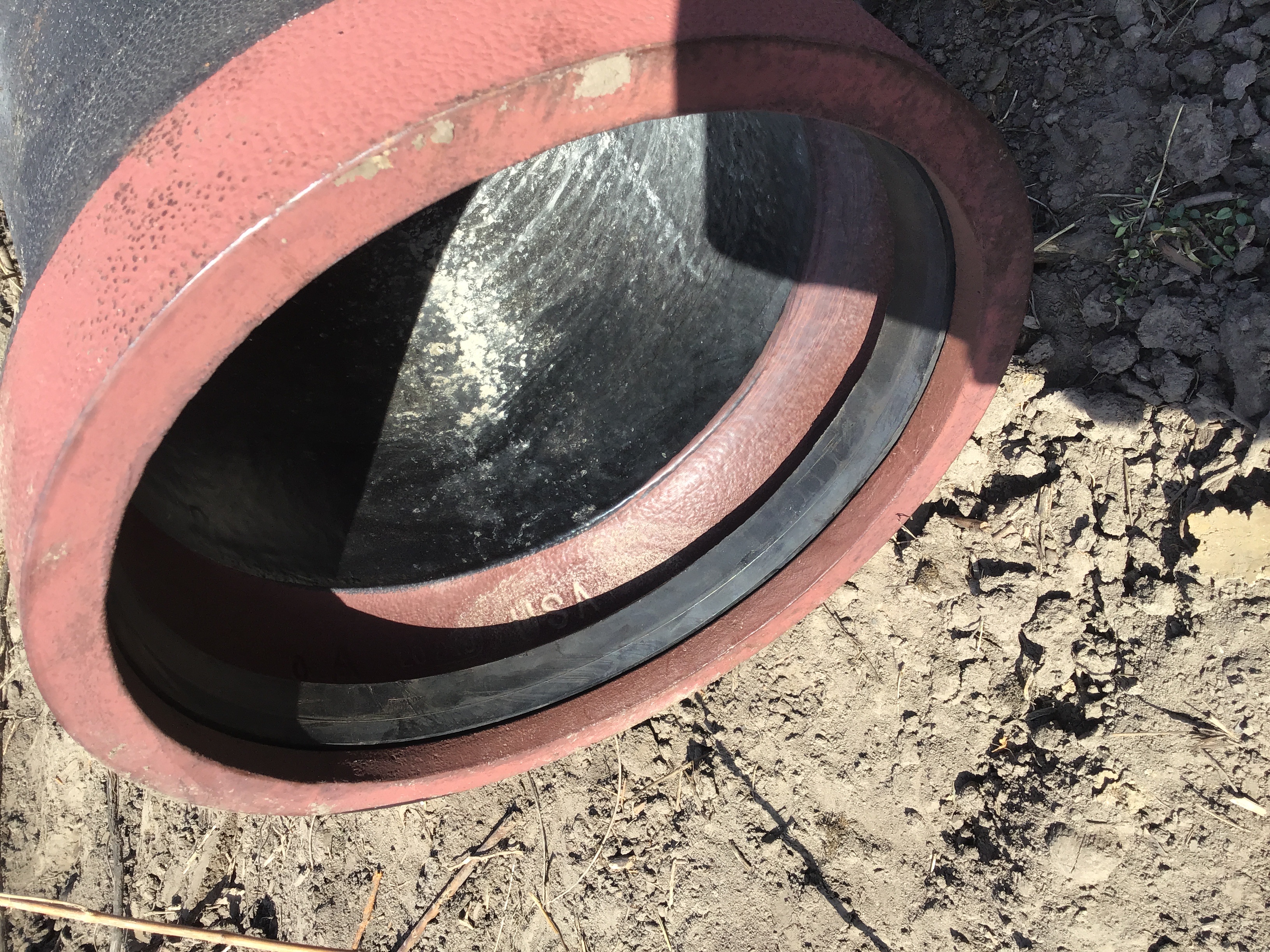

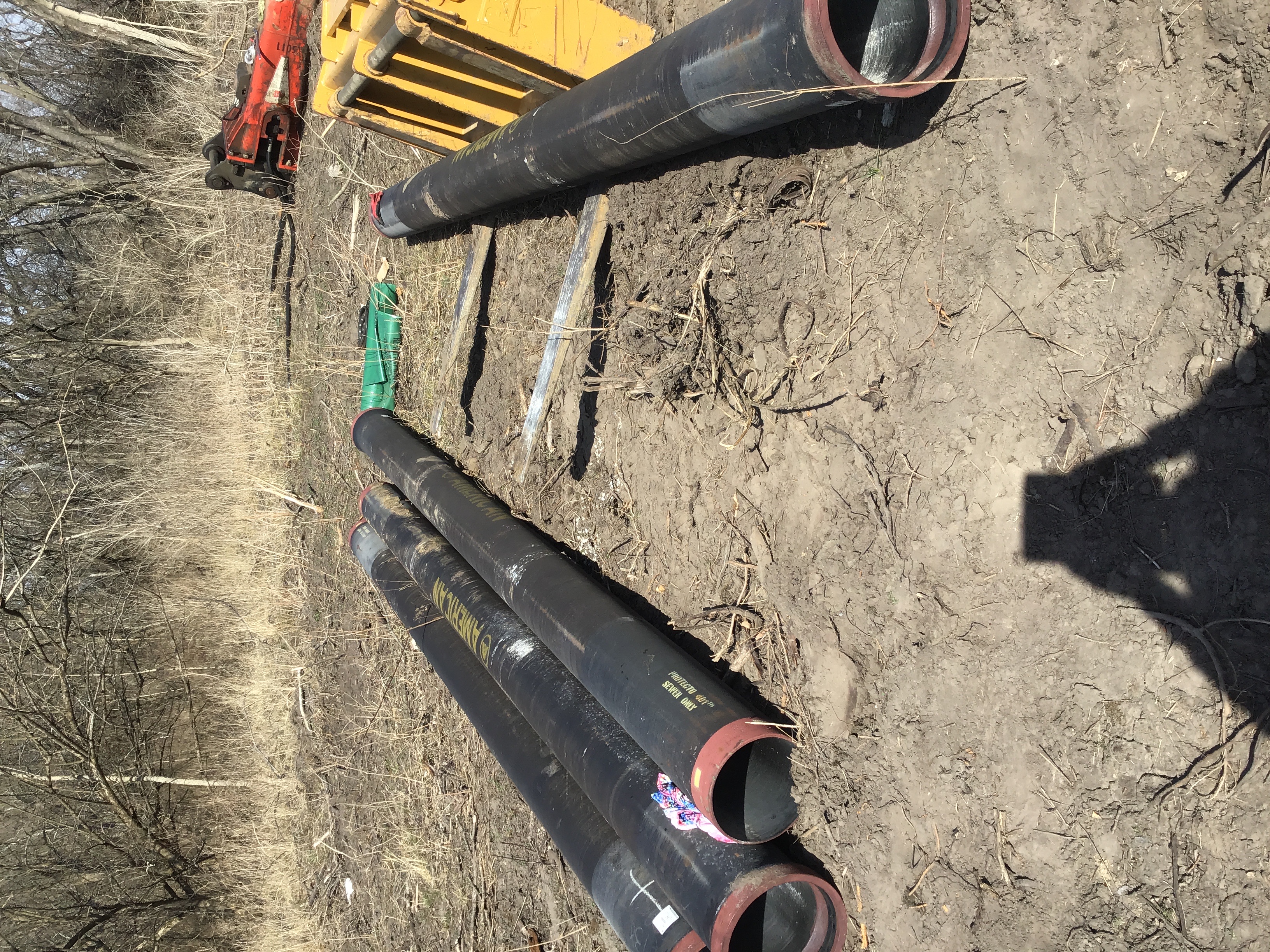

03/08/2021 DI pipe for creek crossing .jpg
03/08/2021 DI pipe creek crossing.jpg
03/08/2021 Failed pipe for crossing.jpg
03/08/2021 DI pipe for crossing.jpg
03/08/2021 Letter INSPECTION SUMMARY
03/08/2021 SS creek crossing from ex mh.jpg

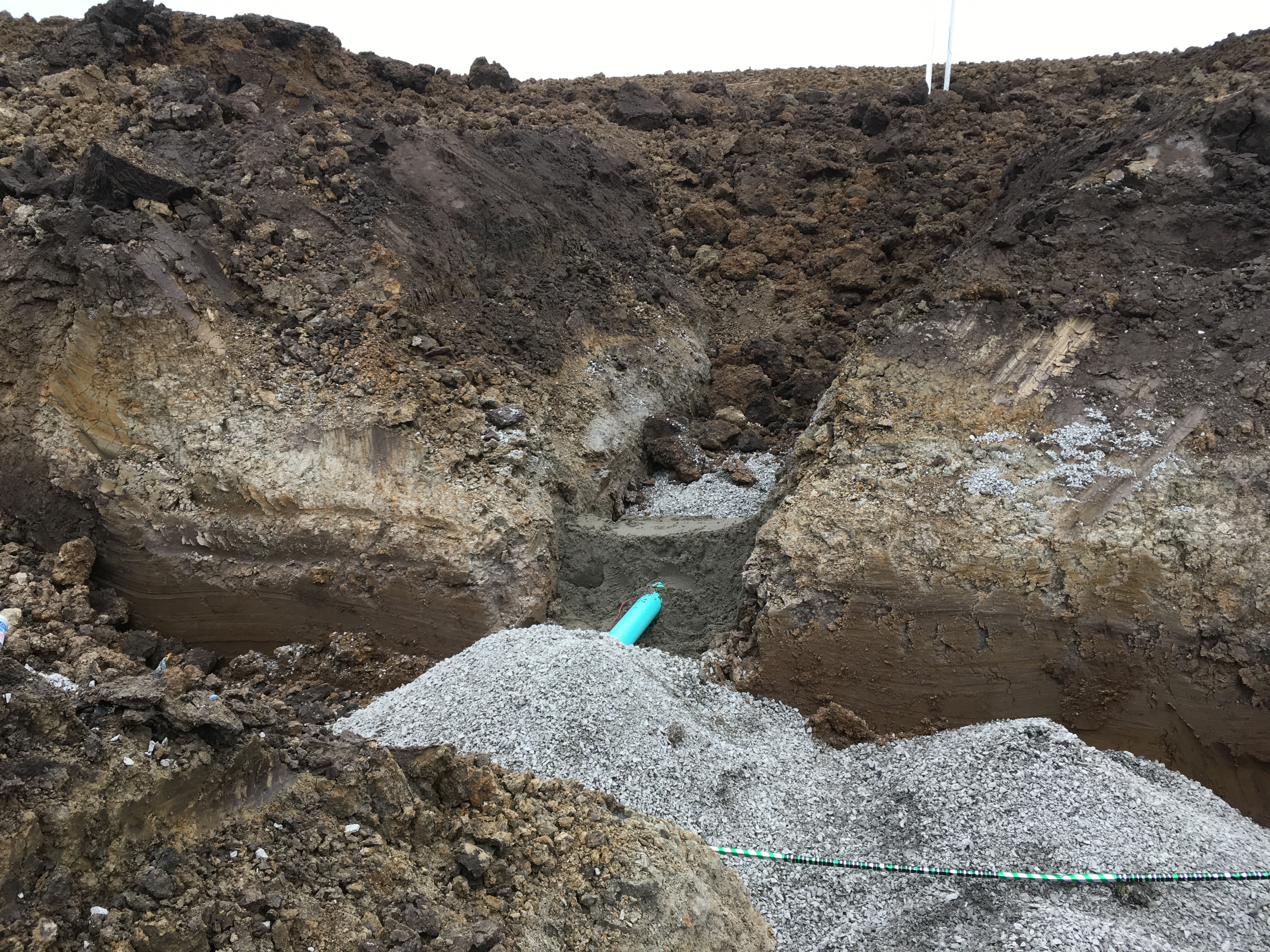

03/09/2021 SS pipe encasement at creek crossing.jpg
03/09/2021 SS MH 1-1.jpg
03/09/2021 Letter INSPECTION SUMMARY
03/09/2021 Letter INSPECTION SUMMARY

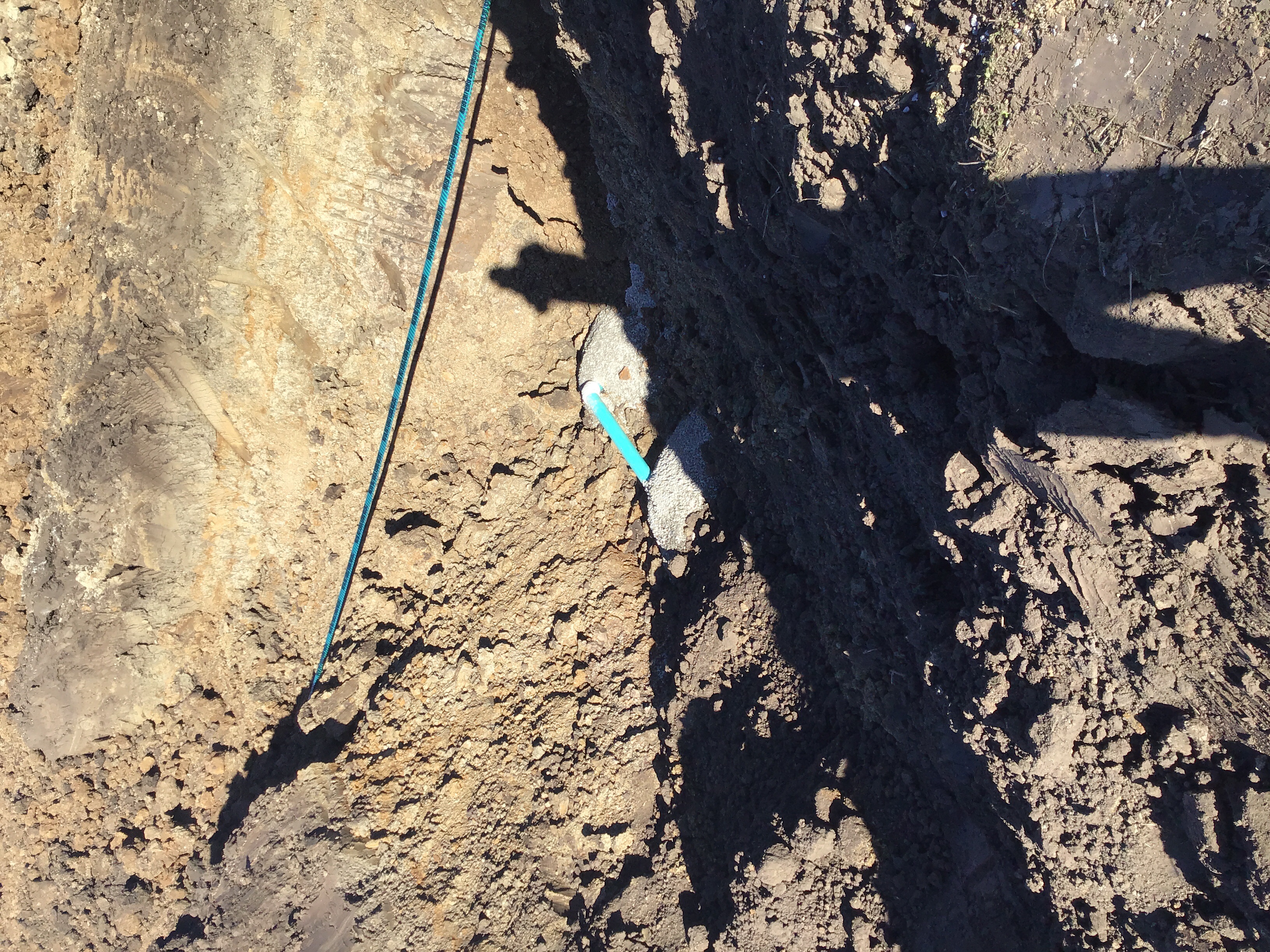

03/09/2021 SS soil issues.jpg
03/30/2021 Letter INSPECTION SUMMARY
04/02/2021 Hook Farms First Plat - Compaction Test Report_2020-12-09 - 2020-12-28 Sanitary Line 1 2
04/02/2021 Hook Farms First Plat - Compaction Test Report_2020-12-09 - 2020-12-28 Sanitary Line 1
04/02/2021 Hook Farms First Plat - Compaction Test Report_2020-12-17 - 2021-01-14 SW Hook Farm Drive
04/02/2021 Hook Farms First Plat - Compaction Test Report_2020-12-28 Sanitary Line 2 1
04/02/2021 Hook Farms First Plat - Compaction Test Report_2020-12-28 Sanitary Line 2
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-12 - 2021-01-18 SW Farm Field Road
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-14 - 2021-01-18 Sanitary Line 2 3
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-14 - 2021-01-18 Sanitary Line 2
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-14 - 2021-01-18 SW Farm Field Court
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-14 Sanitary Line 3 1
04/02/2021 Hook Farms First Plat - Compaction Test Report_2021-01-14 Sanitary Line 3
04/02/2021 Moisture-Density Relationship_7706113
04/02/2021 Moisture-Density Relationship_7706114
04/02/2021 Moisture-Density Relationship_7706115
04/02/2021 The Retreat at Hook Farms - Compaction Test Report_2020-11-18 SW Harvest Moon Lane
04/02/2021 The Retreat at Hook Farms - Compaction Test Report_2020-11-19 - 2020-12-08 SW Hearthstone Place
04/02/2021 The Retreat at Hook Farms - Compaction Test Report_2020-12-02 - 2020-12-08 SW Red Barn Road
04/02/2021 Letter DE-Daily Inspection Summary
04/02/2021 Letter DE-Daily Inspection Summary
04/05/2021 Approved Plans Hook Farms 1st Plat Street & Storm Revised 3.3.21 Re-approved 4.5.21
04/06/2021 Letter INSPECTION SUMMARY
04/06/2021 Letter INSPECTION SUMMARY
04/06/2021 Letter INSPECTION SUMMARY
04/06/2021 Letter INSPECTION SUMMARY
05/06/2021 Letter INSPECTION SUMMARY
05/06/2021 Letter INSPECTION SUMMARY
06/12/2021 Letter INSPECTION SUMMARY
06/14/2021 Letter INSPECTION SUMMARY
07/08/2021 Letter INSPECTION SUMMARY
07/15/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
09/10/2021 Plans Approved 21-09-09_Sanitary As-Builts
09/17/2021 Plans Approved StrtStormMDPASBUILT
10/21/2021 Letter DE-Permit
10/21/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
10/25/2021 Letter DE-Punch List
02/08/2022 Letter INSPECTION SUMMARY
02/11/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY

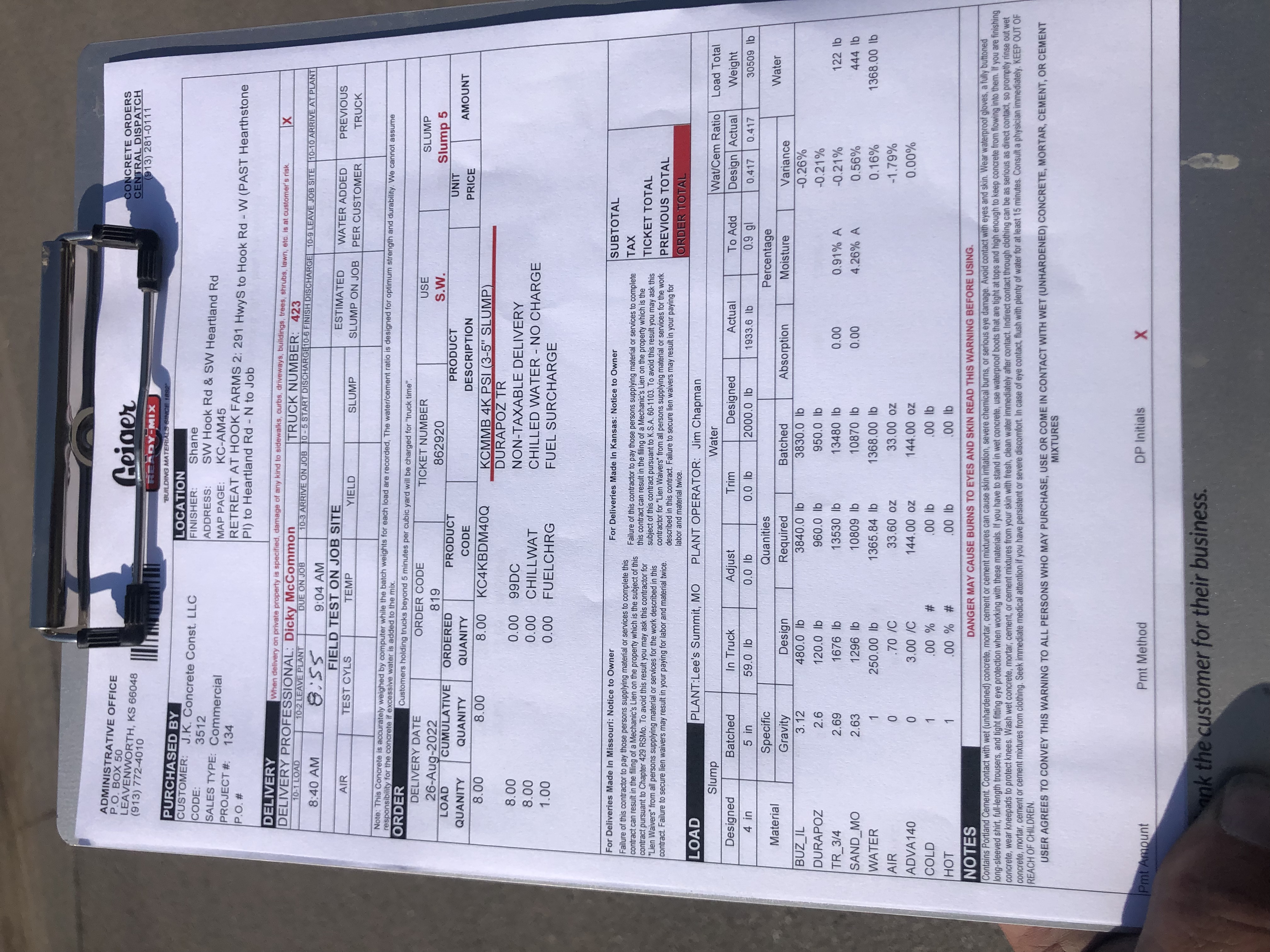

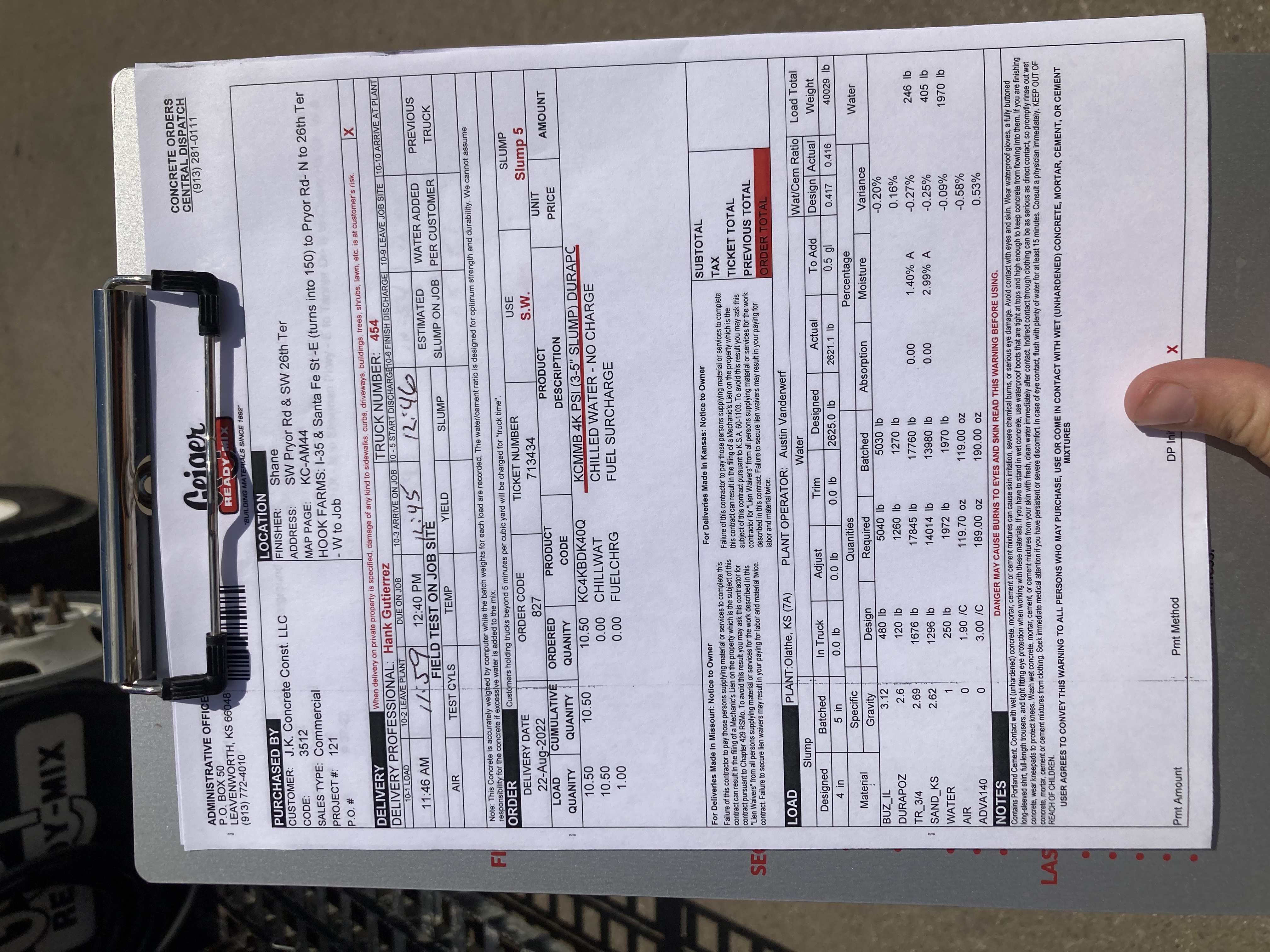

08/22/2022 Activity Document 8-22-22 Concrete ticket
08/22/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/26/2022 Letter INSPECTION SUMMARY
08/26/2022 Activity Document Sidewalk Concrete Ticket 8-26-22
08/30/2022 Letter INSPECTION SUMMARY
09/15/2023 Maintenace Bond
09/15/2023 Final Affidavit
09/15/2023 Letter DE-Certificate of Final Acceptance (Commercial)
05/28/2024 Letter PW ROW Inspections Report
07/29/2024 Letter PW ROW Inspections Report
12/20/2024 Letter PW ROW Inspections Report
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
