Summary

PRSUBD20192191
Public Infrastructure
Final Acceptance
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
STREETS OF WEST PRYOR - PRIVATE ROAD FDP
08/13/2019
08/16/2019
03/01/2024
Locations
Contacts
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
SOSAYA & SONS CONSTRUCTION INC, Address:P O BOX 469, Phone:(913) 745-8800
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
CENTENNIAL WEST PRYOR LLC, Address:3348 PEACHTREE RD NE STE 1000
KATCARELS LLC, Address:PO BOX 850
KATCARELS LLC, Address:6311 VAN NUYS BLVD STE 459
SWP IX LLC, Address:7200 W 132ND ST STE 150
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 08/13/2019 08/16/2019
Joe Starlin
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $159.30 $159.30 Paid Not payable online 08/14/2019
91100C9-Water Insp Fee $11,992.03 $11,992.03 Paid Not payable online 08/14/2019
9110081-Paved Surface Inspection Fee $23,212.02 $23,212.02 Paid Not payable online 08/14/2019
9110071-Site Grading Fee $2,514.90 $2,514.90 Paid Not payable online 08/14/2019
9110073-Right of Way Permit Fee $80.00 $80.00 Paid Not payable online 08/14/2019
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $235.00 $0.00 $235.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid

$335.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water Line - Construction Inspection Partial 11/11/2019 11/12/2019
Misc
Informational
11/11/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Water Line - Construction Inspection Partial 11/12/2019 11/13/2019
Misc
Informational
11/13/2019
11-12-19 01 vault is set and approximately 40ft of 8” pipe is installed.
Water Line - Construction Inspection Partial 11/13/2019 11/13/2019
Misc
Informational
11/13/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/13/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Water Line - Construction Inspection Partial 11/14/2019 11/14/2019
Misc
Informational
11/13/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/13/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/14/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Sanitary Sewer Construction Inspection Partial 11/15/2019 11/15/2019
Misc
Informational
11/15/2019

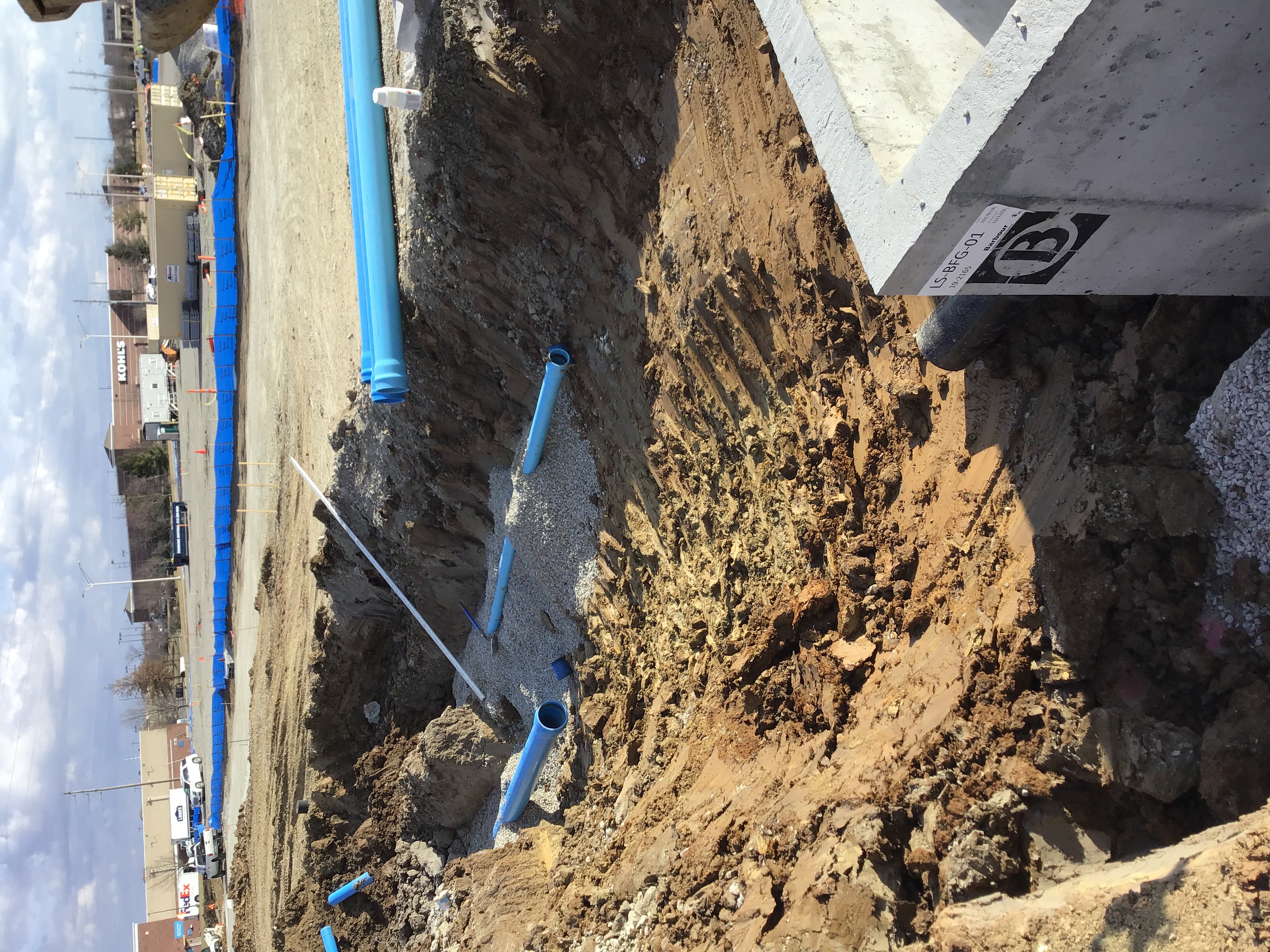

They are digging out a section of the road to run a service line.
Misc
Informational
11/15/2019
They are digging out a section of the road to run a service line. They have installed one service line to the south and are working on the second service line.
Sanitary Sewer Construction Inspection Partial 11/16/2019 11/16/2019
Misc
Informational
11/16/2019
11-16-19 8:09am They are working on the two service lines coming off the main heading to the apartment building. After all the sanitary line is installed they will get compaction tests from the third party inspector in lifts on the last 48” of fill. The compaction tests will be Monday the 18th 11:14am They have the service line ran and rocked. They are working on the backfill.
Sanitary Sewer Construction Inspection Partial 11/18/2019
Misc
Informational
11/15/2019

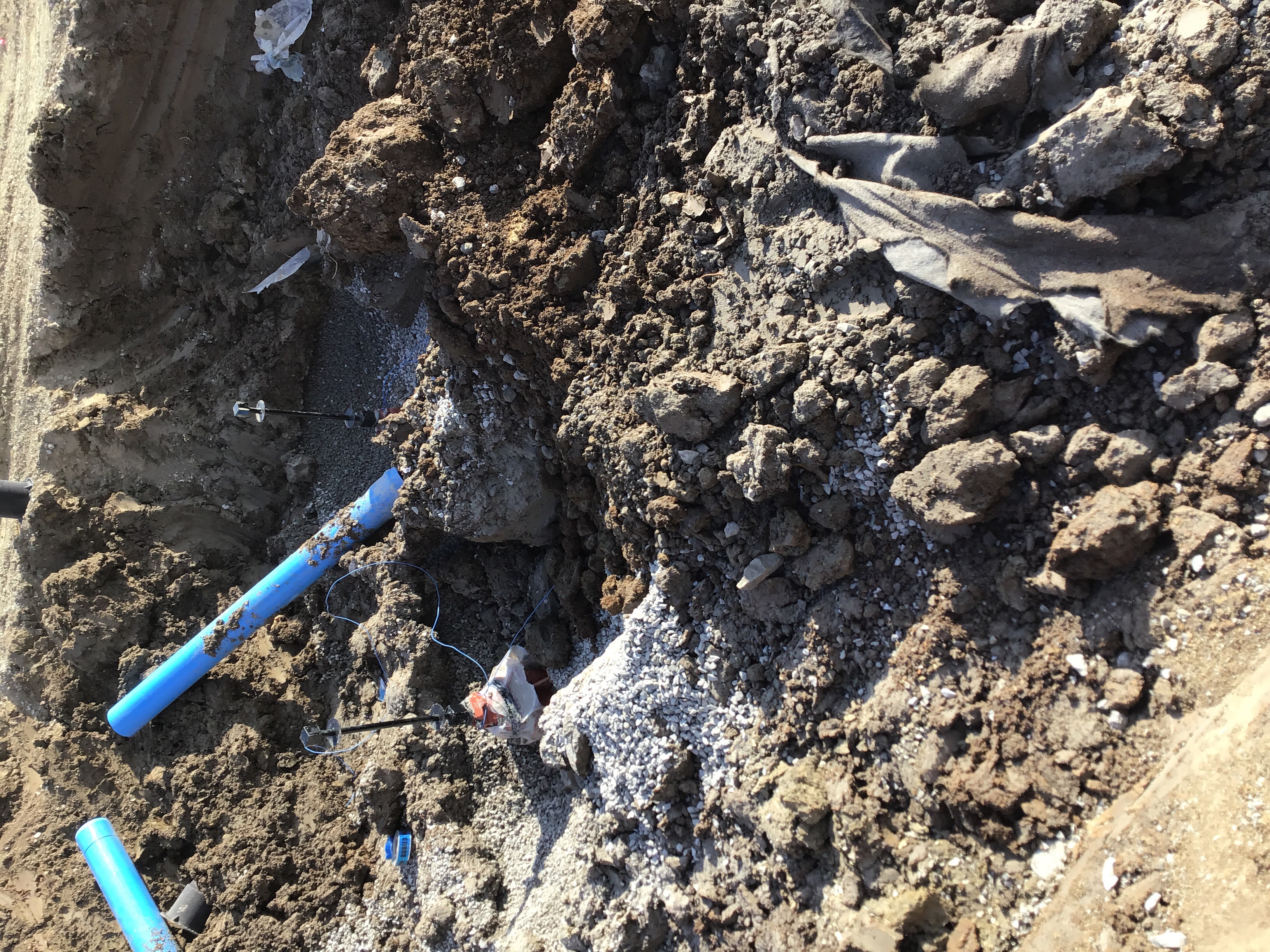

11-15-19 8:35am They are digging down to tie into the sanitary main.
Misc
Informational
11/18/2019
11-18-19 8:10am They have all the service lines installed and are working on backfilling.
Water Line - Construction Inspection Partial 11/18/2019 11/18/2019
Misc
Informational
11/14/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/14/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/14/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/18/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Water Line - Construction Inspection Partial 11/19/2019 11/20/2019
Misc
Informational
11/18/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/18/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/18/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/18/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/19/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/20/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Water Line - Construction Inspection Partial 11/20/2019 11/20/2019
Misc
Informational
11/20/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/20/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/20/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/20/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/20/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/20/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/20/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Curb - Proof Roll Partial 11/21/2019
Misc
Informational
11/21/2019
11-21-19 4:11pm The private roads passed a proof roll with the exception of the curb line on the north east side of the site.
Water Line - Construction Inspection Partial 11/21/2019 11/21/2019
Misc
Informational
11/20/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/20/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/20/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/20/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/20/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/20/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/20/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/21/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/21/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Water Line - Construction Inspection Partial 11/22/2019 11/22/2019
Misc
Informational
11/21/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/21/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/21/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/21/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/21/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/21/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/21/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/21/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/21/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/22/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Grading/Excavation/Fill Inspection Partial 11/25/2019 11/25/2019
Misc
Informational
11/19/2019
11-19-19 7:52am They are laying base rock with geo grid on the private roads.
Misc
Informational
11/21/2019
11-21-19 9:50am They are laying type 5 base rock with geogrid on the north end of the site That runs east and west.
Misc
Informational
11/25/2019
11-25-19 They are preparing to start cutting grade for curb line.
Water Line - Construction Inspection Partial 11/25/2019 11/25/2019
Misc
Informational
11/22/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/22/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/22/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/22/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/22/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/22/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/22/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/22/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/22/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/22/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
11/25/2019

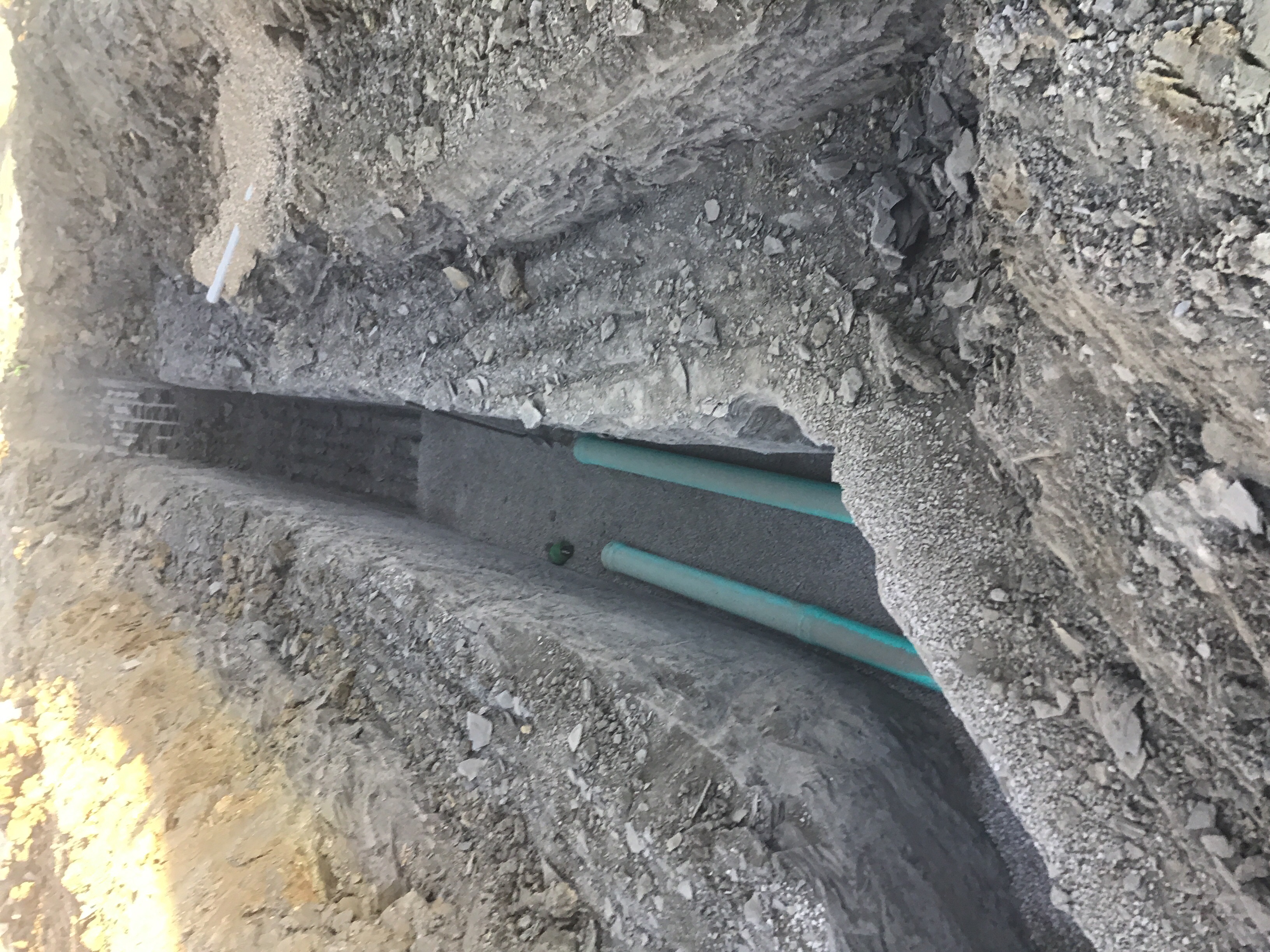

11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Curb - Proof Roll Partial 11/25/2019
Misc
Informational
11/21/2019
11-21-19 4:11pm The private roads passed a proof roll with the exception of the curb line on the north east side of the site.
Misc
Informational
11/25/2019
11-25-19 We are proof rolling at the north east side of the site. There are two sections of curb line that need proof rolled. We will be starting at storm box J-3.1 going down hill to Pryor, then from Pryor up hill to J-3 storm box. 3:15pm There are two corrections that need make. One on each side. Then we will proof roll again.
Curb - Proof Roll Partial 11/26/2019 11/26/2019
Misc
Informational
11/25/2019
11-21-19 4:11pm The private roads passed a proof roll with the exception of the curb line on the north east side of the site.
Misc
Informational
11/25/2019
11-25-19 We are proof rolling at the north east side of the site. There are two sections of curb line that need proof rolled. We will be starting at storm box J-3.1 going down hill to Pryor, then from Pryor up hill to J-3 storm box. 3:15pm There are two corrections that need make. One on each side. Then we will proof roll again.
Misc
Informational
11/26/2019
11-26-19 1:44pm The proof roll passed with a small correction being made at box J-3.
Water Line - Construction Inspection Partial 11/26/2019 11/26/2019
Misc
Informational
11/25/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/25/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/25/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/25/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/25/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/25/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/25/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/25/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/25/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/25/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
11/25/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational

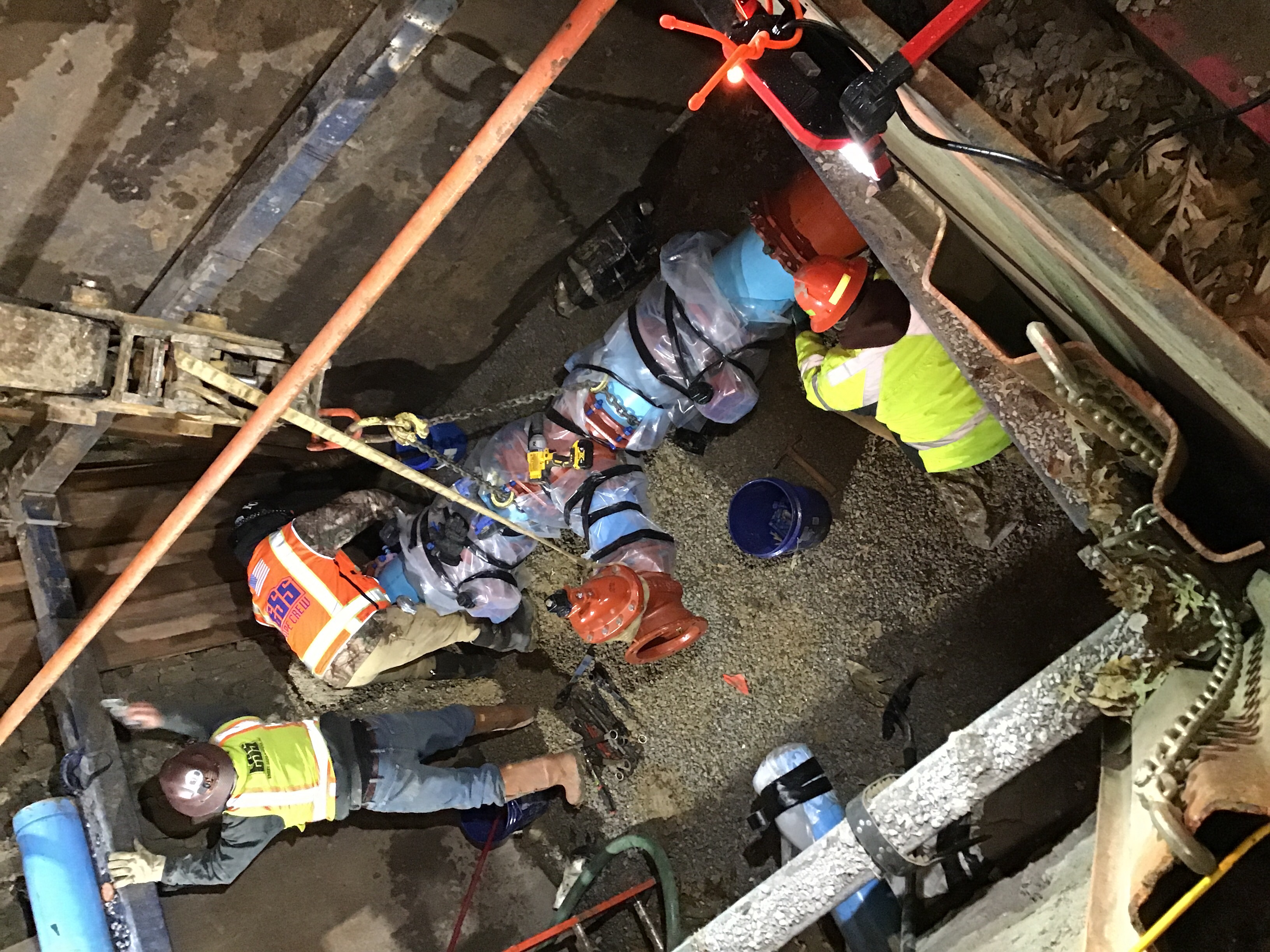

11/26/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Pavement-Curb Construction Partial 11/26/2019 11/26/2019
Misc
Informational
11/26/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
11/26/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
11/26/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Water Line - Construction Inspection Partial 11/26/2019 11/27/2019
Misc
Informational
11/26/2019

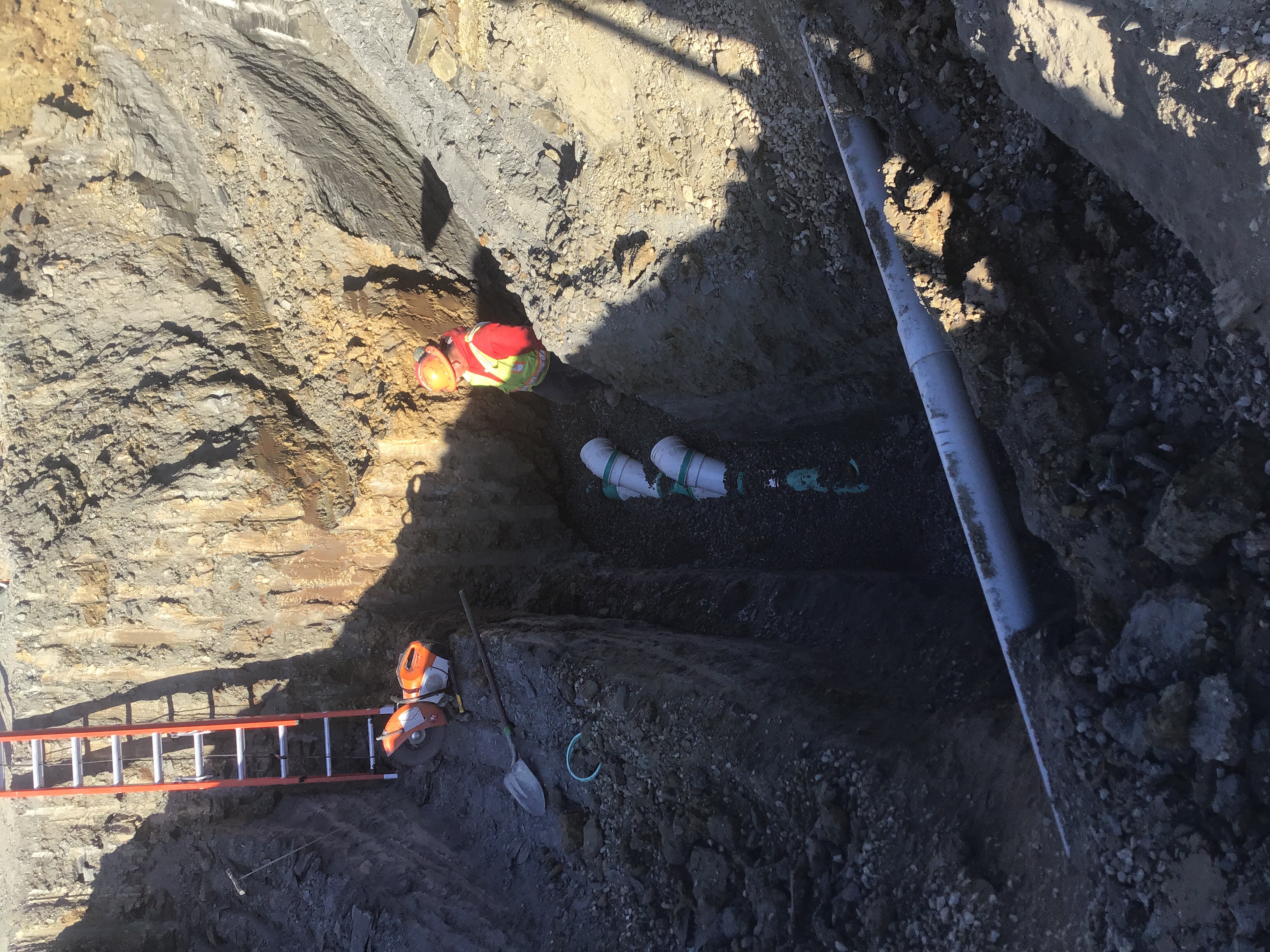

11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/26/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/26/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/26/2019

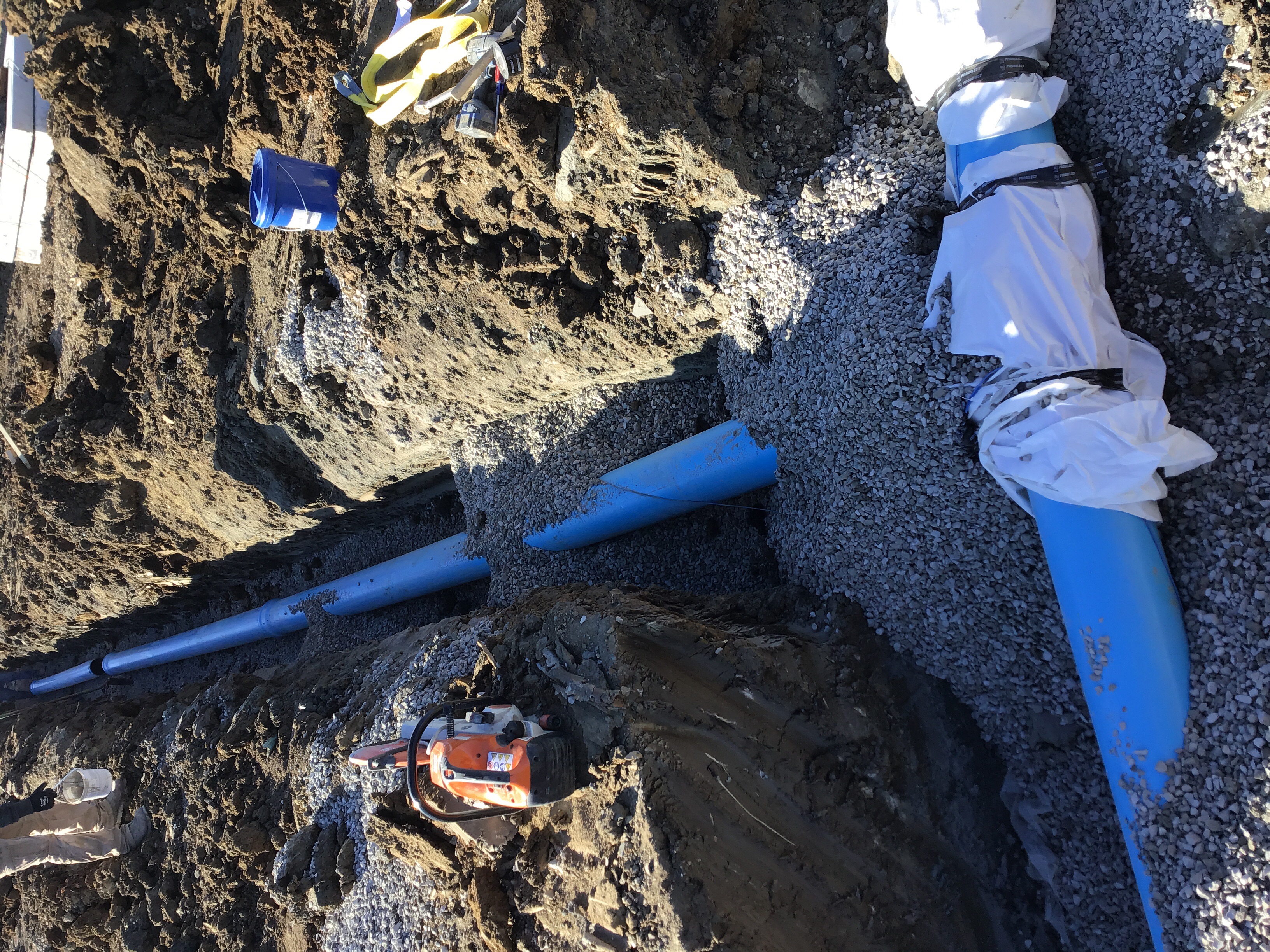

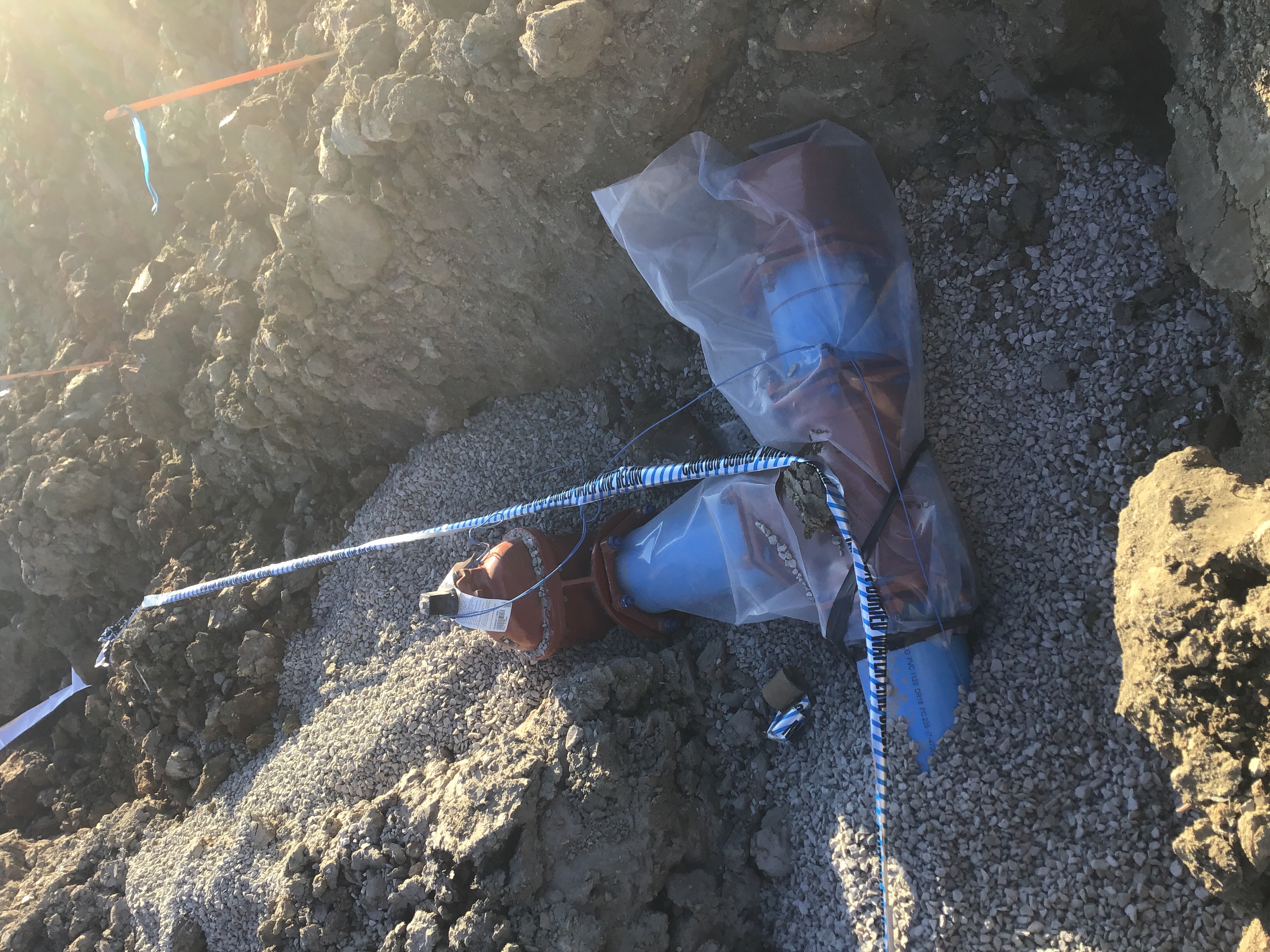

11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
11/26/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
11/26/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/26/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/26/2019

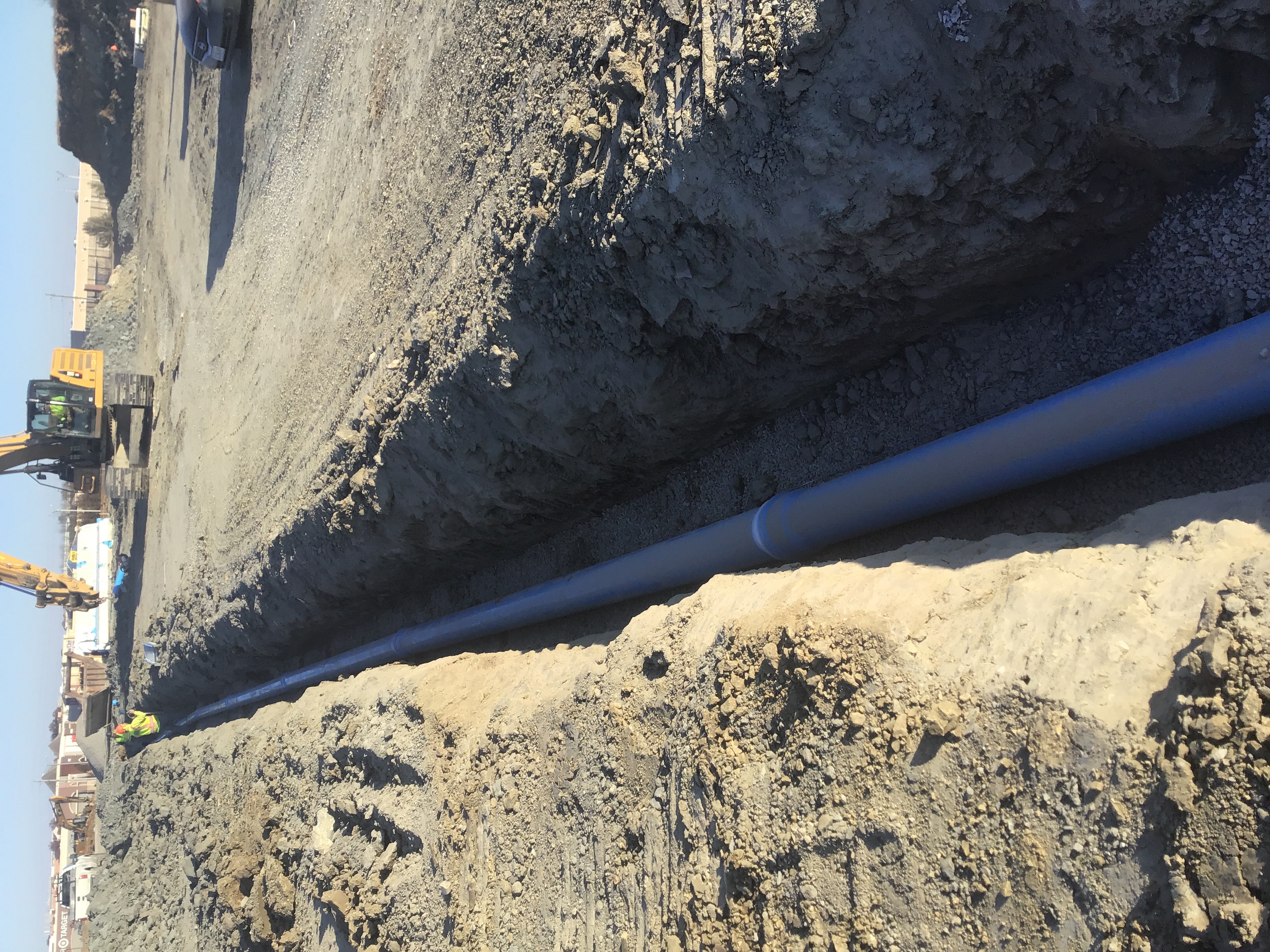

11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/26/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/26/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/26/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/26/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
11/27/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Pavement-Curb Construction Partial 12/2/2019 12/02/2019
Misc
Informational
11/26/2019

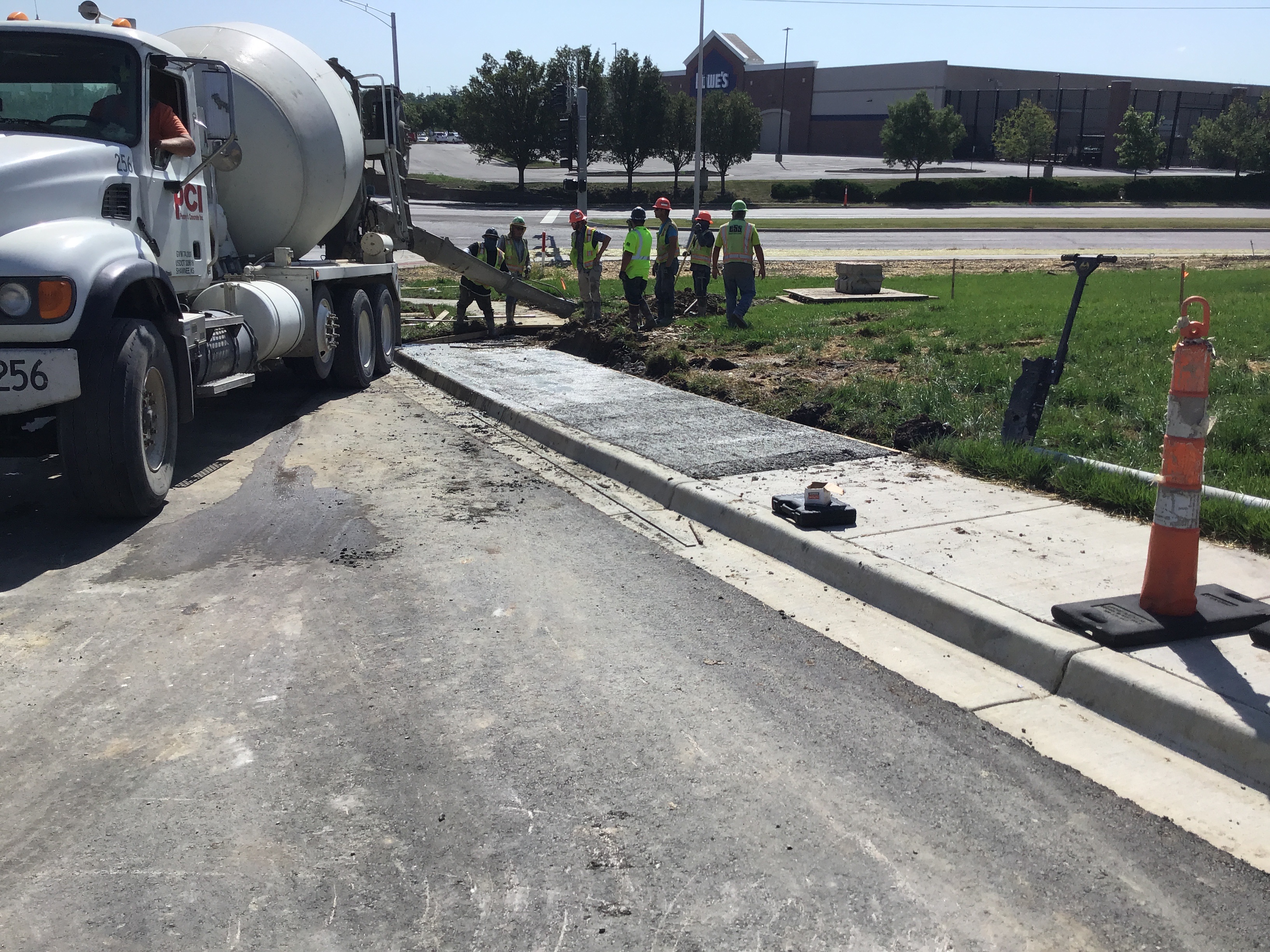

11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
11/26/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
11/26/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
12/02/2019
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Water Line - Construction Inspection Partial 12/2/2019 12/02/2019
Misc
Informational
11/27/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
11/27/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/27/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
11/27/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
11/27/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
11/27/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
11/27/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
11/27/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
11/27/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
11/27/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
11/27/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
11/27/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
11/27/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/02/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This woukld flush are chlorine out that is in the pipe under Pryor.
Water Line - Hydrostatic Test Passed 12/3/2019 12/03/2019
Misc
Informational
12/03/2019
12-3-19 The water line has passed. It held for two hours at 150psi
Pavement-Proof Roll Partial 12/04/2019
Misc
Informational
12/04/2019

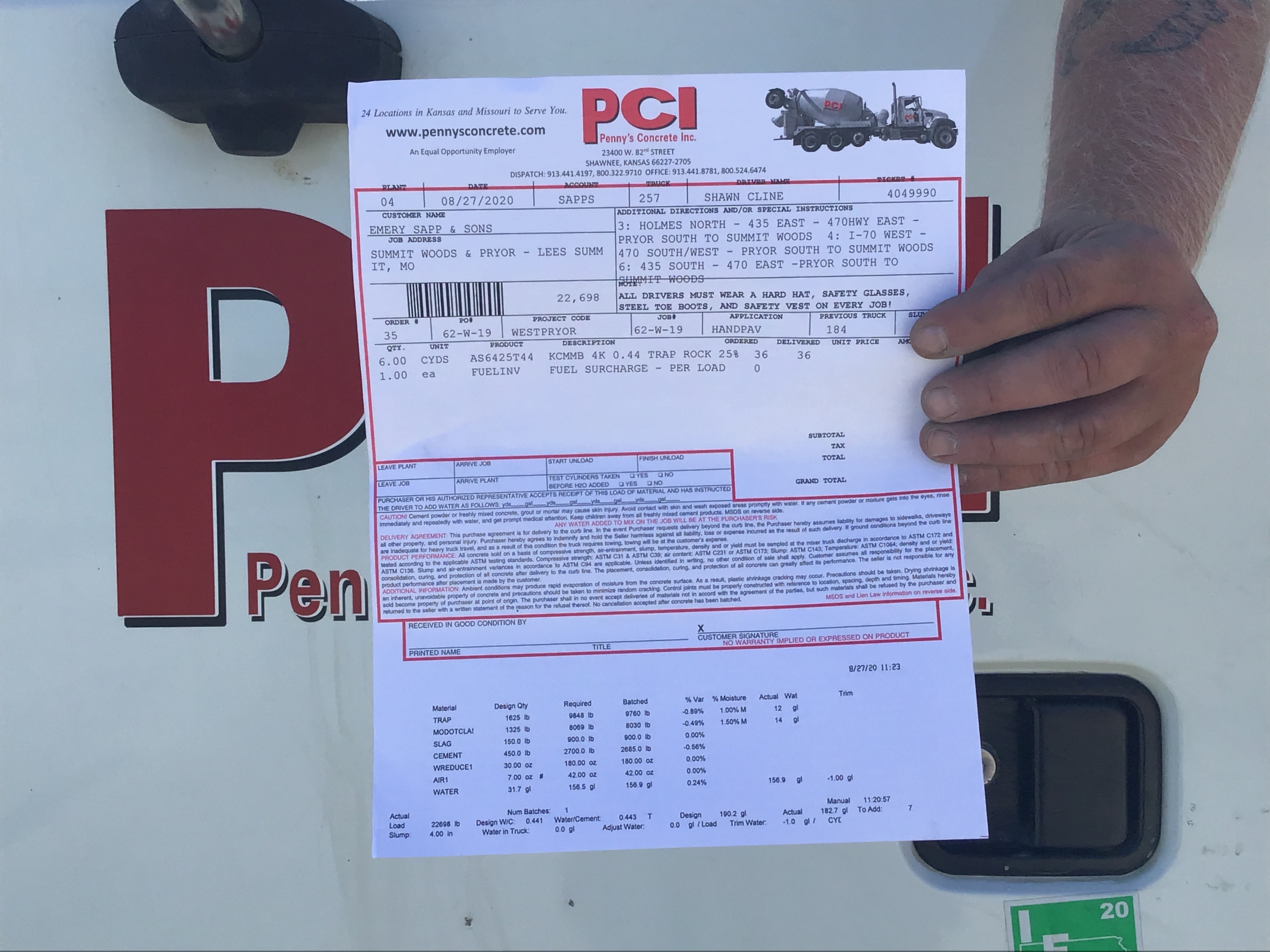

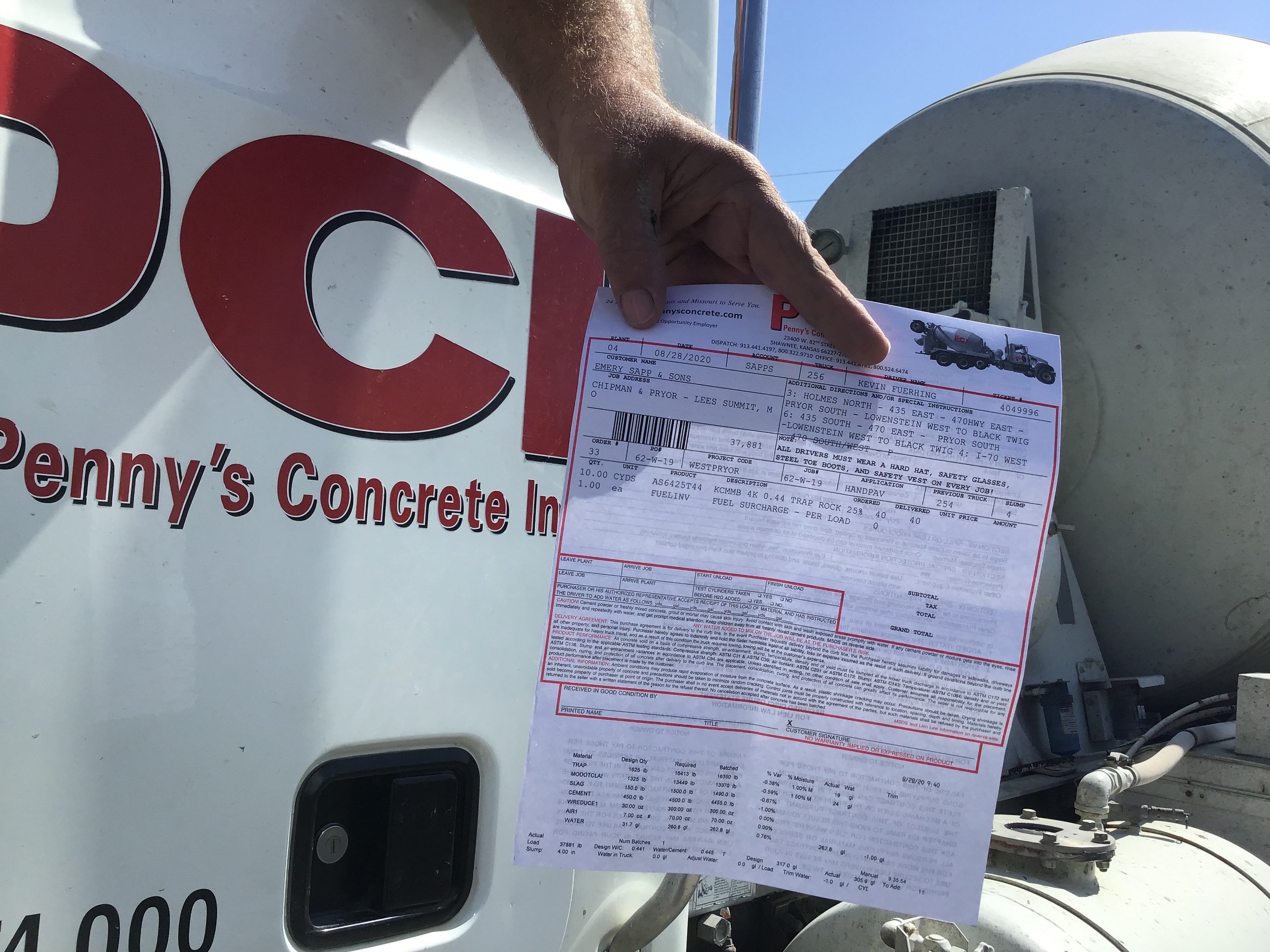

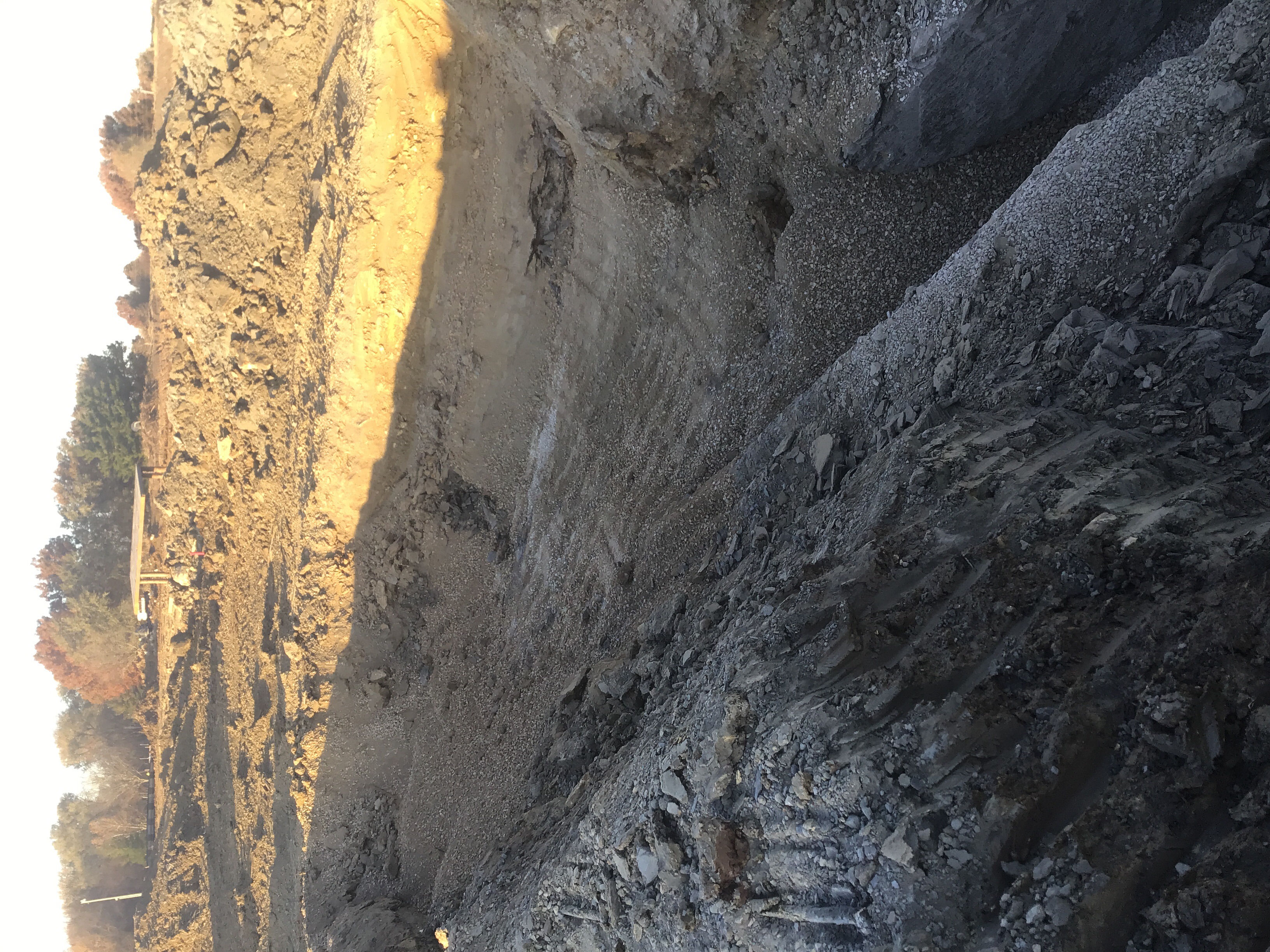

12-3-19 At 1pm John Jackson did a proof roll and failed three spots on the road at the west end of the site. They made corrections. Joe Starlin did a second proof roll at 4:30pm. Two of the three spots failed again. We will perform a third proof roll on 12-4-19 in the afternoon.
Pavement-Curb Construction Partial 12/3/2019 12/04/2019
Misc
Informational
12/02/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
12/02/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
12/02/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
12/02/2019
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Misc
Informational
12/04/2019
12-3-19 They poured curb throats for the storm boxes and the island on the east west road at the north end of the site. The Forman is holding concrete tickets for me.
Water Line - Construction Inspection Partial 12/3/2019 12/04/2019
Misc
Informational
12/02/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/02/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/02/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/02/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/02/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/02/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/02/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/02/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/02/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/02/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/02/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/02/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/02/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/02/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/04/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line.
Water Line - Construction Inspection Partial 12/4/2019 12/04/2019
Misc
Informational
12/04/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/04/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/04/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/04/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/04/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/04/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/04/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/04/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/04/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/04/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/04/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/04/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/04/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/04/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/04/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Pavement-Proof Roll Partial 12/4/2019 12/04/2019
Misc
Informational
12/04/2019
12-3-19 At 1pm John Jackson did a proof roll and failed three spots on the road at the west end of the site. They made corrections. Joe Starlin did a second proof roll at 4:30pm. Two of the three spots failed again. We will perform a third proof roll on 12-4-19 in the afternoon.
Misc
Informational
12/04/2019
12-4-19 We proof rolled the west side corrections and are now going to the north side of the site to proof roll the east west road that leads to Pryor. Everything east of C-1 manhole has failed and will need corrections.
Pavement-Proof Roll Partial 12/5/2019 12/05/2019
Misc
Informational
12/04/2019
12-3-19 At 1pm John Jackson did a proof roll and failed three spots on the road at the west end of the site. They made corrections. Joe Starlin did a second proof roll at 4:30pm. Two of the three spots failed again. We will perform a third proof roll on 12-4-19 in the afternoon.
Misc
Informational
12/04/2019
12-4-19 We proof rolled the west side corrections and are now going to the north side of the site to proof roll the east west road that leads to Pryor. Everything east of C-1 manhole has failed and will need corrections.
Misc
Informational
12/05/2019
12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site.
Misc
Informational
12/05/2019
12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site. 8:05am We proof rolled from C-1 manhole down to Pryor rd. Mike with CFS was on site for the proof roll. There are to be two corrections made at the east side of the storm inlets by Pryor rd. They are going to dig out approximately 3 inches of base and add more asphalt base in these areas. Mike thought this would be the best solution. Mike will also be witnessing this correction and may do testing.
Water Line - Construction Inspection Partial 12/6/2019 12/06/2019
Misc
Informational
12/04/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/04/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/04/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/04/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/04/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/04/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/04/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/04/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/04/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/04/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/04/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/04/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/04/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/04/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/04/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/06/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Pavement-Surface Partial 12/6/2019 12/06/2019
Misc
Informational
12/04/2019
12-4-19 8:53am The first trucks are here to start laying the asphalt. They have started at Lowenstein by the park. Larry had to repair manhole D2 so that it would be on grade. 1:54pm Mike with CFS has informed me that all testing is going good. They are turning the corner at the north end of the site and will be laying asphalt heading to the east.
Misc
Informational
12/06/2019

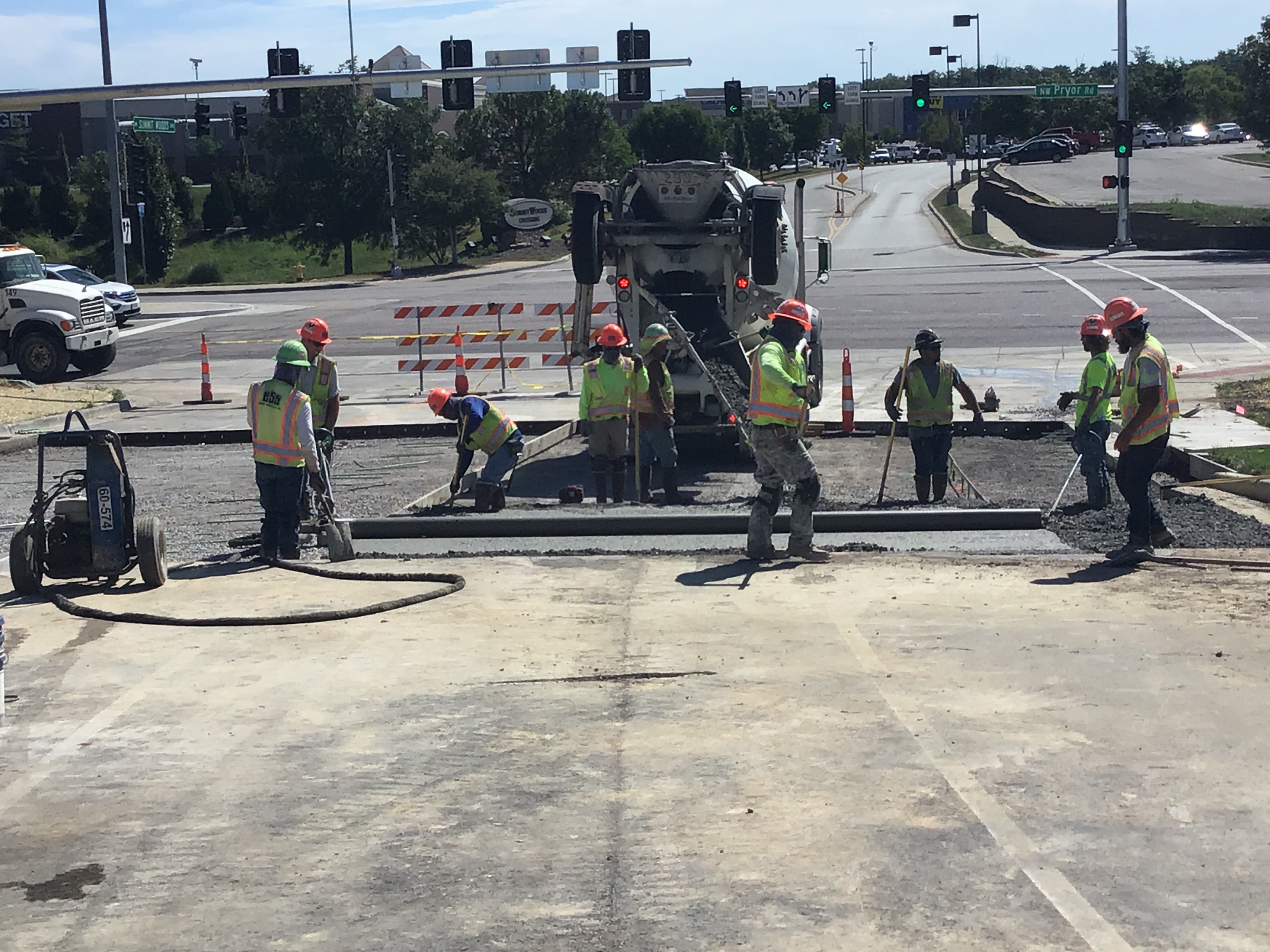

12-6-19 They have laid the asphalt down to Pryor. CFS was on site doing testing and said all tests and temps were good.
Water - Material Verification Passed 12/10/2019
Water Line - Construction Inspection Partial 12/9/2019 12/10/2019
Misc
Informational
12/06/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/06/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/06/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/06/2019

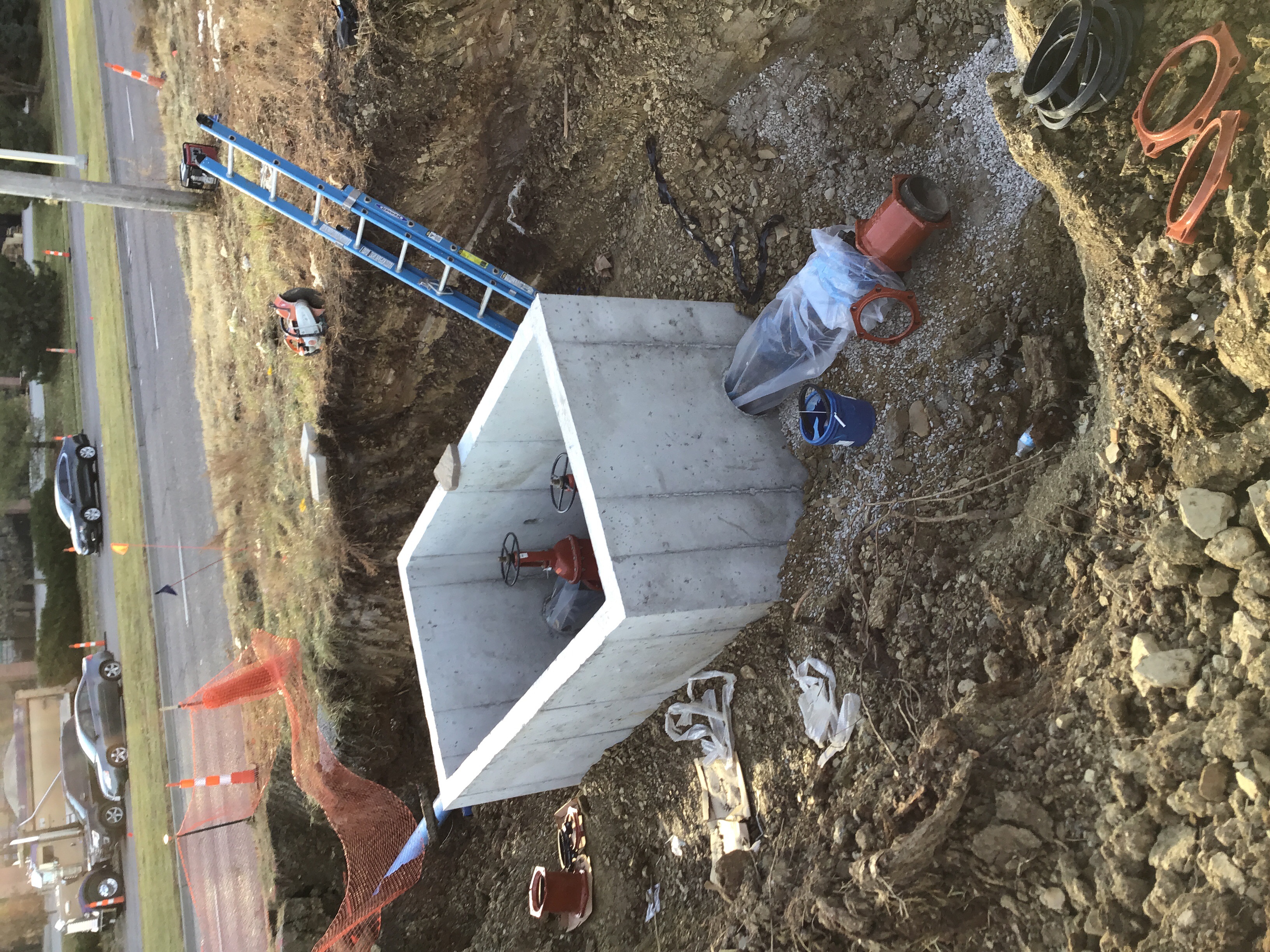

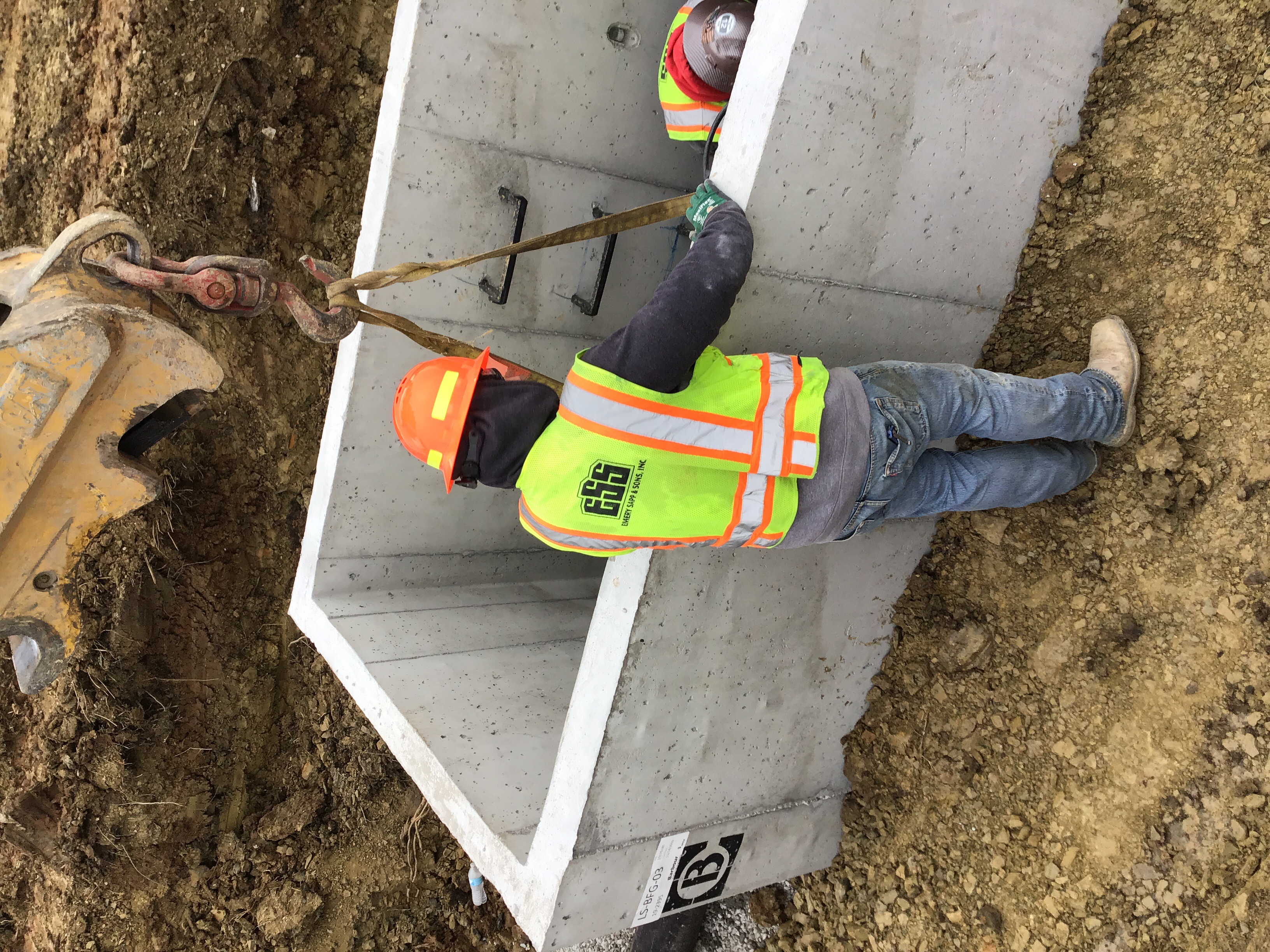

11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/06/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/06/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/06/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/06/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/06/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/06/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/06/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/06/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/06/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/06/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/06/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/06/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Misc
Informational
12/09/2019
12-9-19 8:30am They are digging out for the vault on the south end of the site. We are at the north end of the site on the corner of the A road to flush the chlorine out of the waterline. The waterline is flushed coming from Lowenstein and we are flushing from Pryor now. The water line is flushed and we will start pulling samples on 12-10-19. They now have the vault set and waterline ran to it. They are pouring thrust blocks and will cover them with blankets.
Water Line - Coliform Test 1 Partial 12/10/2019 12/10/2019
Misc
Informational
12/10/2019
12-10-19 10:39am We have finished pulling all samples. Samples were dropped off at 11:14am.
Water Line - Coliform Test 2 Partial 12/11/2019 12/11/2019
Misc
Informational
12/11/2019
12-11-19 10:07am We have pulled the first of 6 samples. 10:38am we pulled the last sample. 11:13am The samples are dropped off.
Water Line - Construction Inspection Partial 12/10/2019 12/11/2019
Misc
Informational
12/10/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/10/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/10/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/10/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/10/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/10/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/10/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/10/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/10/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/10/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/10/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/10/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/10/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/10/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/10/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/10/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Misc
Informational
12/10/2019
12-9-19 8:30am They are digging out for the vault on the south end of the site. We are at the north end of the site on the corner of the A road to flush the chlorine out of the waterline. The waterline is flushed coming from Lowenstein and we are flushing from Pryor now. The water line is flushed and we will start pulling samples on 12-10-19. They now have the vault set and waterline ran to it. They are pouring thrust blocks and will cover them with blankets.
Misc
Informational
12/10/2019
12-10-19 They are working on the waterline on the south end of the site.
Misc
Informational
12/11/2019
12-11-19 2:17pm They have 10 sticks of waterline installed and are busting rock. They are working on the south east side of the site. Rudys crew.
Water Line - Construction Inspection Partial 12/12/2019 12/12/2019
Misc
Informational
12/11/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/11/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/11/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/11/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/11/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/11/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/11/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/11/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/11/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/11/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/11/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/11/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/11/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/11/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/11/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/11/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Misc
Informational
12/11/2019
12-9-19 8:30am They are digging out for the vault on the south end of the site. We are at the north end of the site on the corner of the A road to flush the chlorine out of the waterline. The waterline is flushed coming from Lowenstein and we are flushing from Pryor now. The water line is flushed and we will start pulling samples on 12-10-19. They now have the vault set and waterline ran to it. They are pouring thrust blocks and will cover them with blankets.
Misc
Informational
12/11/2019
12-10-19 They are working on the waterline on the south end of the site.
Misc
Informational
12/11/2019
12-11-19 2:17pm They have 10 sticks of waterline installed and are busting rock. They are working on the south east side of the site. Rudys crew.
Misc
Informational
12/12/2019
12-12-19 They have set the tee that will feed lot 10. They will be pouring thrust blocks later today. 1:40pm They are digging across the road to install a Fire hydrant. 2:55pm They have set the hydrant by storm box L1. They have poured all thrust blocks.
Water Line - Construction Inspection Partial 12/17/2019 12/17/2019
Misc
Informational
12/12/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/12/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/12/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/12/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/12/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/12/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/12/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/12/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/12/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/12/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/12/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/12/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/12/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/12/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/12/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/12/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Misc
Informational
12/12/2019
12-9-19 8:30am They are digging out for the vault on the south end of the site. We are at the north end of the site on the corner of the A road to flush the chlorine out of the waterline. The waterline is flushed coming from Lowenstein and we are flushing from Pryor now. The water line is flushed and we will start pulling samples on 12-10-19. They now have the vault set and waterline ran to it. They are pouring thrust blocks and will cover them with blankets.
Misc
Informational
12/12/2019
12-10-19 They are working on the waterline on the south end of the site.
Misc
Informational
12/12/2019
12-11-19 2:17pm They have 10 sticks of waterline installed and are busting rock. They are working on the south east side of the site. Rudys crew.
Misc
Informational
12/12/2019
12-12-19 They have set the tee that will feed lot 10. They will be pouring thrust blocks later today. 1:40pm They are digging across the road to install a Fire hydrant. 2:55pm They have set the hydrant by storm box L1. They have poured all thrust blocks.
Misc
Informational
12/17/2019
12-17-19 1:19pm They flushed the chlorine out of the waterline running north to south. We will be pulling samples tomorrow.
Water Line - Coliform Test 1 Partial 12/18/2019
Misc
Informational
12/10/2019
12-10-19 10:39am We have finished pulling all samples. Samples were dropped off at 11:14am.
Misc
Informational
12/18/2019
12-18-19 9:43am We arepulling a water sample at the end of the line by Lot 10. The sample was pulled at 9:50am. Heading to Blue Valley Lab. The sample was dropped off at 10:28am.
Water Line - Coliform Test 2 Partial 12/19/2019 12/20/2019
Misc
Informational
12/11/2019
12-11-19 10:07am We have pulled the first of 6 samples. 10:38am we pulled the last sample. 11:13am The samples are dropped off.
Misc
Informational
12/12/2019
12-12-19 1:44pm We pulled a sample from location E and I’m taking it to the lab. 2:19pm I have dropped off the sample.
Misc
Informational
12/20/2019
12-19-19 1:02pm We are pulling the second sample. The sample is dropped of at Blue Vally Lab.
Pavement-Proof Roll Partial 3/3/2020 03/03/2020
Misc
Informational
12/05/2019

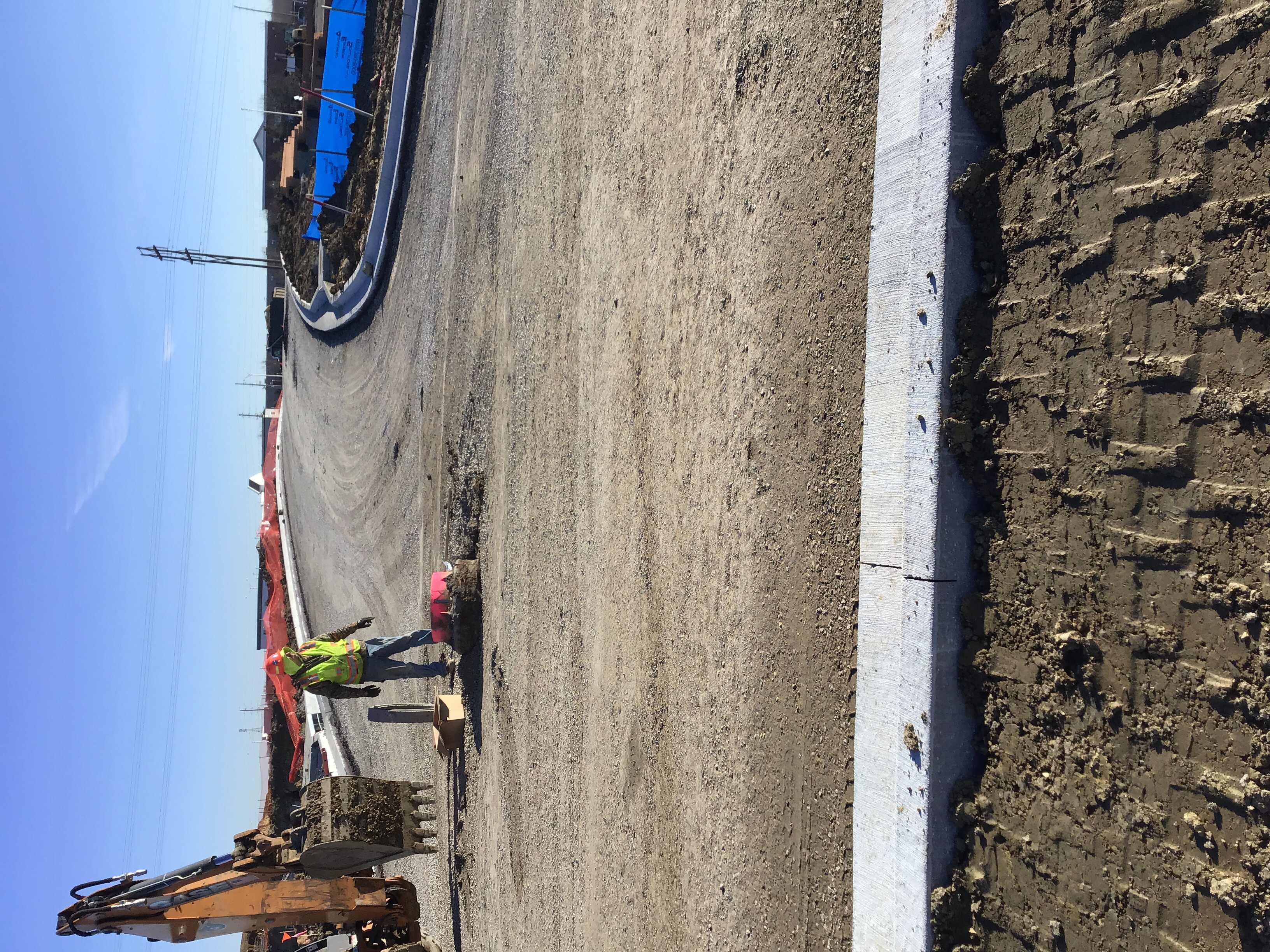

12-3-19 At 1pm John Jackson did a proof roll and failed three spots on the road at the west end of the site. They made corrections. Joe Starlin did a second proof roll at 4:30pm. Two of the three spots failed again. We will perform a third proof roll on 12-4-19 in the afternoon.
Misc
Informational
12/05/2019
12-4-19 We proof rolled the west side corrections and are now going to the north side of the site to proof roll the east west road that leads to Pryor. Everything east of C-1 manhole has failed and will need corrections.
Misc
Informational
12/05/2019

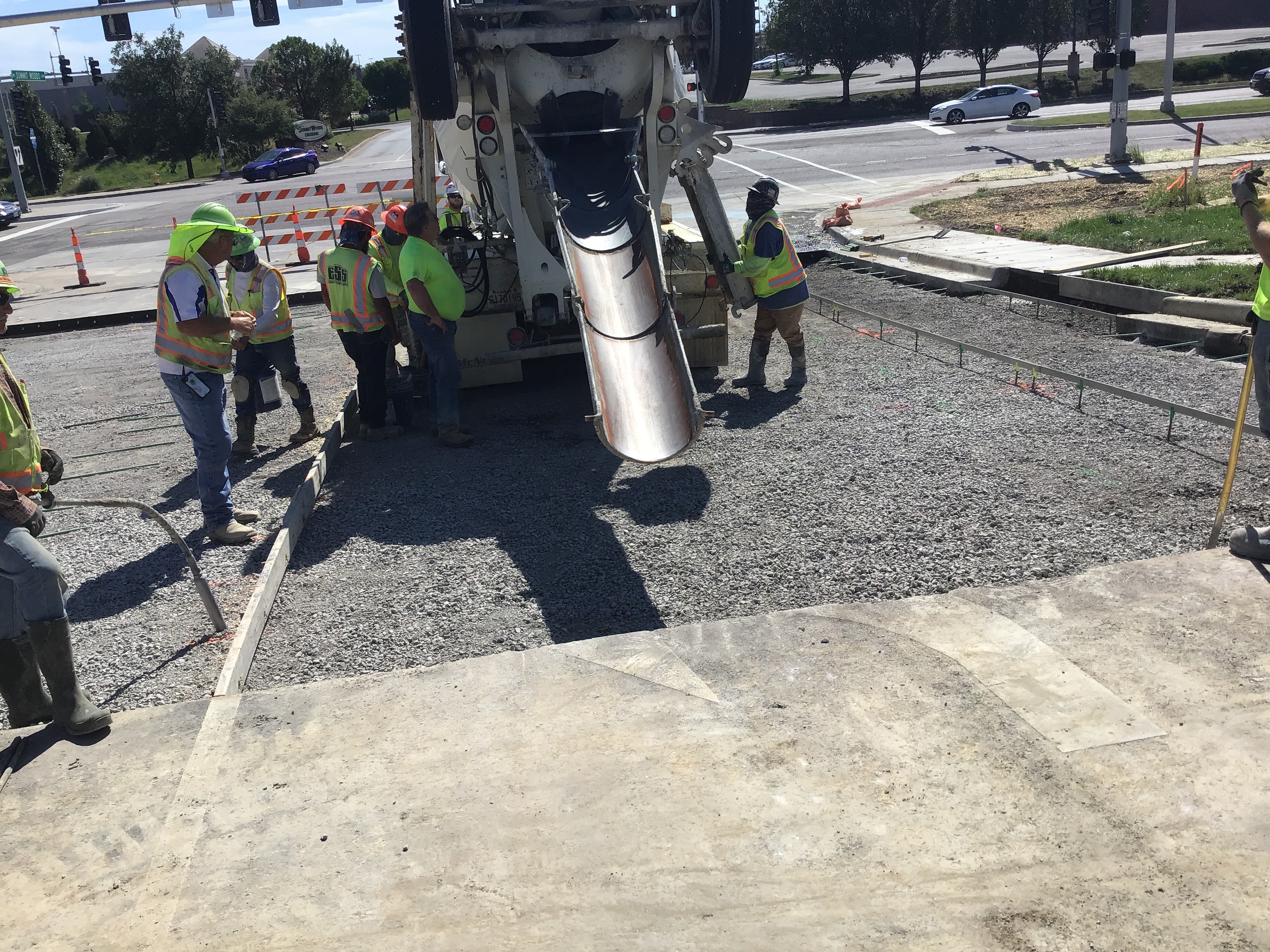

12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site.
Misc
Informational
12/05/2019
12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site. 8:05am We proof rolled from C-1 manhole down to Pryor rd. Mike with CFS was on site for the proof roll. There are to be two corrections made at the east side of the storm inlets by Pryor rd. They are going to dig out approximately 3 inches of base and add more asphalt base in these areas. Mike thought this would be the best solution. Mike will also be witnessing this correction and may do testing.
Misc
Informational
03/03/2020
3-3-20 9:56am We are proof rolling private road B for the curb. 40+50 to 43 plus balls. The proof roll has passed.
Pavement-Surface Partial 3/11/2020 03/11/2020
Misc
Informational
12/06/2019

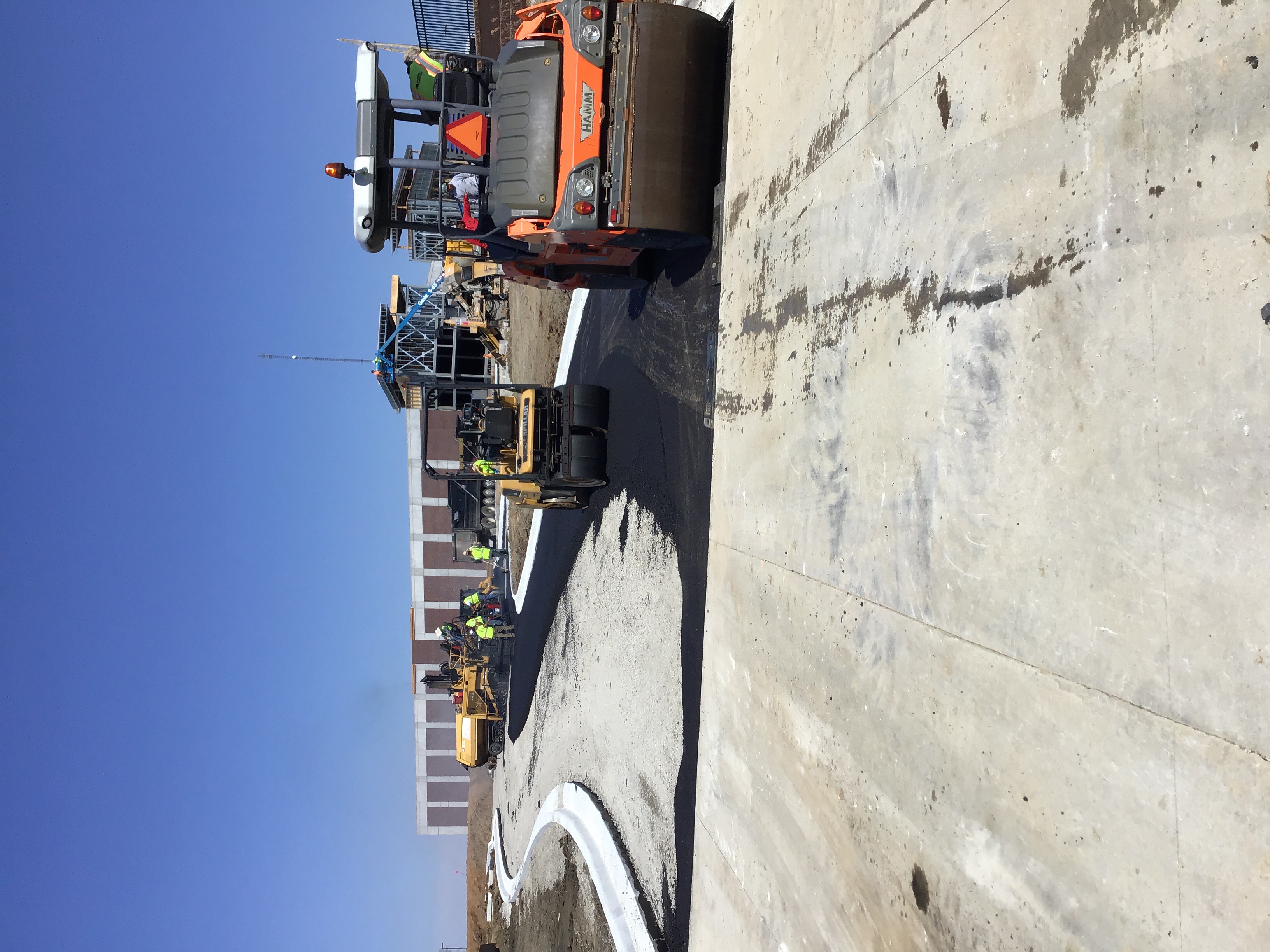

12-4-19 8:53am The first trucks are here to start laying the asphalt. They have started at Lowenstein by the park. Larry had to repair manhole D2 so that it would be on grade. 1:54pm Mike with CFS has informed me that all testing is going good. They are turning the corner at the north end of the site and will be laying asphalt heading to the east.
Misc
Informational
12/06/2019
12-6-19 They have laid the asphalt down to Pryor. CFS was on site doing testing and said all tests and temps were good.
Misc
Informational
03/11/2020
3-11-20 They have milled out the bad base at Private Road A and Pryor along with the surface for the turn lane on Pryor for Lowenstein. They will be laying new base asphalt on Private Road A. CFS is on site and will be doing gradation test and density test on the asphalt. Mike for CFS did probes on the subgrade and confirmed that is was solid. 3:01pm They have poured the base asphalt on private road A. I have collected all the tickets but one. Mike with CFS has one of the tickets.
Pavement-Proof Roll Passed 3/30/2020 03/30/2020
Misc
Informational
03/03/2020
12-3-19 At 1pm John Jackson did a proof roll and failed three spots on the road at the west end of the site. They made corrections. Joe Starlin did a second proof roll at 4:30pm. Two of the three spots failed again. We will perform a third proof roll on 12-4-19 in the afternoon.
Misc
Informational
03/03/2020
12-4-19 We proof rolled the west side corrections and are now going to the north side of the site to proof roll the east west road that leads to Pryor. Everything east of C-1 manhole has failed and will need corrections.
Misc
Informational
03/03/2020
12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site.
Misc
Informational
03/03/2020
12-5-19 7:53am We are waiting on the truck for a proof roll. The truck was to be on site at 7:30am and is not on site. 8:05am We proof rolled from C-1 manhole down to Pryor rd. Mike with CFS was on site for the proof roll. There are to be two corrections made at the east side of the storm inlets by Pryor rd. They are going to dig out approximately 3 inches of base and add more asphalt base in these areas. Mike thought this would be the best solution. Mike will also be witnessing this correction and may do testing.
Misc
Informational
03/03/2020
3-3-20 9:56am We are proof rolling private road B for the curb. 40+50 to 43 plus balls. The proof roll has passed.
Misc
Informational
03/30/2020
3-30-20 8:29am We are proof rolling approximately 300’ of the private road B at Lowenstein. 8:41am It has passed the proof roll. They will be laying base asphalt on it at 10:30am.
Pavement-Surface Partial 3/30/2020 03/30/2020
Misc
Informational
03/11/2020
12-4-19 8:53am The first trucks are here to start laying the asphalt. They have started at Lowenstein by the park. Larry had to repair manhole D2 so that it would be on grade. 1:54pm Mike with CFS has informed me that all testing is going good. They are turning the corner at the north end of the site and will be laying asphalt heading to the east.
Misc
Informational
03/11/2020
12-6-19 They have laid the asphalt down to Pryor. CFS was on site doing testing and said all tests and temps were good.
Misc
Informational
03/11/2020
3-11-20 They have milled out the bad base at Private Road A and Pryor along with the surface for the turn lane on Pryor for Lowenstein. They will be laying new base asphalt on Private Road A. CFS is on site and will be doing gradation test and density test on the asphalt. Mike for CFS did probes on the subgrade and confirmed that is was solid. 3:01pm They have poured the base asphalt on private road A. I have collected all the tickets but one. Mike with CFS has one of the tickets.
Misc
Informational
03/30/2020
3-30-20 10:46am Metro is on site to start laying base asphalt on private road B. 11:20am There are no trucks on site at this time. 11:46am The trucks have arrived and are laying base asphalt. CFS is on site for testing. 1:20pm They have just Finnished with the base.
Street - Surface Course Partial 3/30/2020 03/30/2020
Misc
Informational
03/30/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Street - Surface Course Partial 3/31/2020 03/31/2020
Misc
Informational
03/30/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
03/31/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
03/31/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Sidewalk Inspection Partial 4/29/2020 04/29/2020
Misc
Informational
04/29/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers.
Misc
Informational
04/29/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers. They have forms set and most of the aggregate in place.
Sidewalk Inspection Partial 5/1/2020 05/01/2020
Misc
Informational
04/29/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers.
Misc
Informational
04/29/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers. They have forms set and most of the aggregate in place. 5-1-20 2:18am ESS has poured the sidewalk on the west side of private road B. They will be pouring 60’ of sidewalk on Chipman rd as well.
Site Visit Partial 5/4/2020 05/04/2020
Misc
Informational
05/04/2020
5-4-20 ESS was on site cleaning up and cutting out driveways for the curb machine whe they pour. The rain is moving in so they will be shutting down for the day.
Site Visit Partial 5/11/2020 05/11/2020
Misc
Informational
05/04/2020
5-4-20 ESS was on site cleaning up and cutting out driveways for the curb machine whe they pour. The rain is moving in so they will be shutting down for the day. 5-11-20 They have dug out the construction entrance on Pryor and Private road C.
Pavement-Proof Roll Partial 5/21/2020 05/21/2020
Misc
Informational
05/21/2020
5-21-20 Steve Robbins inspected the proof roll on 5-20-20 on all of the Private road cube line. Road B and C.
Pavement-Curb Construction Partial 05/21/2020
Misc
Informational
12/04/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
12/04/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
12/04/2019
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
12/04/2019
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Misc
Informational
12/04/2019
12-3-19 They poured curb throats for the storm boxes and the island on the east west road at the north end of the site. The Forman is holding concrete tickets for me. 5-21-20 ESS has poured the curb on private roads C and along private road B.
Pavement-Curb Construction Partial 5/27/2020 5/27/2020 05/27/2020
Misc
Informational
05/21/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
05/21/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
05/21/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
05/21/2020
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Misc
Informational
05/21/2020
12-3-19 They poured curb throats for the storm boxes and the island on the east west road at the north end of the site. The Forman is holding concrete tickets for me. 5-21-20 ESS has poured the curb on private roads C and along private road B. 5-27-20 ESS are setting up inlet throats along Private road C and B. They have poured throats and have moved out to Pryor to set up for pours.
Pavement-Proof Roll Partial 6/1/2020 6/1/2020 06/01/2020
Misc
Informational
05/21/2020
5-21-20 Steve Robbins inspected the proof roll on 5-20-20 on all of the Private road cube line. Road B and C. 6-1-20 The proof roll failed at Summit Woods and Pryor intersection. At private road C and Pryor the north side of the intersection has passed and the south side will need corrections.
Pavement-Curb Construction Partial 06/01/2020
Misc
Informational
05/27/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
05/27/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
05/27/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
05/27/2020
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Misc
Informational
05/27/2020
12-3-19 They poured curb throats for the storm boxes and the island on the east west road at the north end of the site. The Forman is holding concrete tickets for me. 5-21-20 ESS has poured the curb on private roads C and along private road B. 5-27-20 ESS are setting up inlet throats along Private road C and B. They have poured throats and have moved out to Pryor to set up for pours. 6-1-20 2:11pm They have poured part of the drive for Private road C and are now pouring the curb on the north side of the drive for C road. They poured the Island on A road.
Pavement-Curb Construction Partial 6/8/2020 6/8/2020 06/08/2020
Misc
Informational
06/01/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb.
Misc
Informational
06/01/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
06/01/2020
11-26-19 9:04am They have started pouring curb on the east west rd. They are using the curb machine and have CFS doing all test. There will be field cures for the curb. 1:30pm They have poured the curb on the south west side that’ leads to Lowenstein.
Misc
Informational
06/01/2020
12-2-19 8:47am They are setting up the throats for the storm boxes and will be pouring them later today when the temp gets above freezing. 2:06pm They have three throats poured and will have six total for the day. They are using an excelerator to help the concrete set up.
Misc
Informational
06/01/2020
12-3-19 They poured curb throats for the storm boxes and the island on the east west road at the north end of the site. The Forman is holding concrete tickets for me. 5-21-20 ESS has poured the curb on private roads C and along private road B. 5-27-20 ESS are setting up inlet throats along Private road C and B. They have poured throats and have moved out to Pryor to set up for pours. 6-1-20 2:11pm They have poured part of the drive for Private road C and are now pouring the curb on the north side of the drive for C road. They poured the Island on A road. 6-8-20 8:58am ESS areuring curb on Private road B at the north end of the job site. ESS is pouring the curb at the drive of Summit Woods.
Driveway Inspection Partial 6/9/2020 6/9/2020 06/09/2020
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete. 2:34pm They have poured half of the drive and have set forms for the other half.
Driveway Inspection Partial 6/11/2020 6/11/2020 06/11/2020
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/09/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete. 2:34pm They have poured half of the drive and have set forms for the other half.6-11-20 7:57am ESS are pouring the rest of the drive at Summit Woods and Pryor.
Street - Surface Course Partial 6/11/2020 6/11/2020 06/11/2020
Misc
Informational
03/31/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
03/31/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
03/31/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor.
Street - Surface Course Partial 6/28/2020 6/28/2020 06/28/2020
Misc
Informational
06/11/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
06/11/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
06/11/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor. 6-28-20 11:33am They are laying surface asphalt on Private Rd A. They left a text message with John DiMauro at 8:45pm 6-27-20 saying that they were working today. 12:30pm They are using Type 3 recycled. They have completed Private Rd A and are now working on Private Rd B laying surface. Tempature of the asphalt out of the truck is 265 degrees. 3:25pm One more truck and they will have Private Rd. B complete. 4:08pm They have completed the private roads.
Underground Electrical Inspection - Commercial Partial 7/8/2020 07/08/2020
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
07/08/2020
- (1)LIGHT POLE BASE NW CORNER AT OVERHEAD POWER LINES CAGE & CONDUIT COMPLETE -
Underground Electrical Inspection - Commercial Partial 7/10/2020 7/10/2020 07/10/2020
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
07/08/2020
- (1)LIGHT POLE BASE NW CORNER AT OVERHEAD POWER LINES CAGE & CONDUIT COMPLETE - - (3) SOUTH ENTRANCE (3) NORTH ENTRANCE AT PRYOR LIGHT POLE BASE CAGE W/ CONDUIT COMPLETE -
Underground Electrical Inspection - Commercial Partial 7/13/2020 7/13/2020 07/13/2020
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
07/10/2020
- (1)LIGHT POLE BASE NW CORNER AT OVERHEAD POWER LINES CAGE & CONDUIT COMPLETE - - (3) SOUTH ENTRANCE (3) NORTH ENTRANCE AT PRYOR LIGHT POLE BASE CAGE W/ CONDUIT COMPLETE - - (1) LIGHT POLE BASE NORTH ENTRANCE -
Underground Electrical Inspection - Commercial Partial 7/14/2020 7/14/2020 07/14/2020
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
07/13/2020
- (1)LIGHT POLE BASE NW CORNER AT OVERHEAD POWER LINES CAGE & CONDUIT COMPLETE - - (3) SOUTH ENTRANCE (3) NORTH ENTRANCE AT PRYOR LIGHT POLE BASE CAGE W/ CONDUIT COMPLETE - - (1) LIGHT POLE BASE NORTH ENTRANCE - - UNDERGROUND CONDUIT (3) POLE BASES SOUTH (5) POLE BASES NORTH (2) JUNCTION BOXES NORTH -
Site Visit Partial 07/20/2020
Misc
Informational
05/11/2020
5-4-20 ESS was on site cleaning up and cutting out driveways for the curb machine whe they pour. The rain is moving in so they will be shutting down for the day. 5-11-20 They have dug out the construction entrance on Pryor and Private road C. 7-20-20 7:30am The contractors keep moving the road block signs and cutting through. There is no other activity on site at this time.
Sidewalk Inspection Partial 08/06/2020
Misc
Informational
05/01/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers.
Misc
Informational
05/01/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers. They have forms set and most of the aggregate in place. 5-1-20 2:18am ESS has poured the sidewalk on the west side of private road B. They will be pouring 60’ of sidewalk on Chipman rd as well. 8-6-20 9:11am Bob Burns and I are on site to look at the sidewalk on private road B at the south end of the site. They need to remove the curb and install a ramp.
Street - Surface Course Partial 8/24/2020 8/24/2020 08/24/2020
Misc
Informational
06/28/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
06/28/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
06/28/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor. 6-28-20 11:33am They are laying surface asphalt on Private Rd A. They left a text message with John DiMauro at 8:45pm 6-27-20 saying that they were working today. 12:30pm They are using Type 3 recycled. They have completed Private Rd A and are now working on Private Rd B laying surface. Tempature of the asphalt out of the truck is 265 degrees. 3:25pm One more truck and they will have Private Rd. B complete. 4:08pm They have completed the private roads. 8-24-20 2:39pm ESS are tearing out the asphalt on Private road A to replace with concrete.
Sidewalk Inspection Partial 08/28/2020
Misc
Informational
08/06/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers.
Misc
Informational
08/06/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers. They have forms set and most of the aggregate in place. 5-1-20 2:18am ESS has poured the sidewalk on the west side of private road B. They will be pouring 60’ of sidewalk on Chipman rd as well. 8-6-20 9:11am Bob Burns and I are on site to look at the sidewalk on private road B at the south end of the site. They need to remove the curb and install a ramp.
Misc
Informational
08/28/2020

8/28/20 Friday 10:58 Contractor poured 40’ of sidewalk on the Southside Street (near concrete street pour )NW Summit Wood xing.
Site Visit Partial 09/03/2020
Misc
Informational
07/20/2020
5-4-20 ESS was on site cleaning up and cutting out driveways for the curb machine whe they pour. The rain is moving in so they will be shutting down for the day. 5-11-20 They have dug out the construction entrance on Pryor and Private road C. 7-20-20 7:30am The contractors keep moving the road block signs and cutting through. There is no other activity on site at this time. 9-3-20 9AM Steve Robbins and I met with the developer and contractors to go over the roads and road closed signs.
Sidewalk Inspection Passed 09/04/2020
Misc
Informational
08/28/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers.
Misc
Informational
08/28/2020
4-29-20 9:13am They are setting up sidewalk on the west side of private road B going from Lowenstein to McKeevers. They have forms set and most of the aggregate in place. 5-1-20 2:18am ESS has poured the sidewalk on the west side of private road B. They will be pouring 60’ of sidewalk on Chipman rd as well. 8-6-20 9:11am Bob Burns and I are on site to look at the sidewalk on private road B at the south end of the site. They need to remove the curb and install a ramp.
Misc
Informational
08/28/2020
8/28/20 Friday 10:58 Contractor poured 40’ of sidewalk on the Southside Street (near concrete street pour )NW Summit Wood xing.
Street - Concrete Passed 09/04/2020
Misc
Informational
08/28/2020

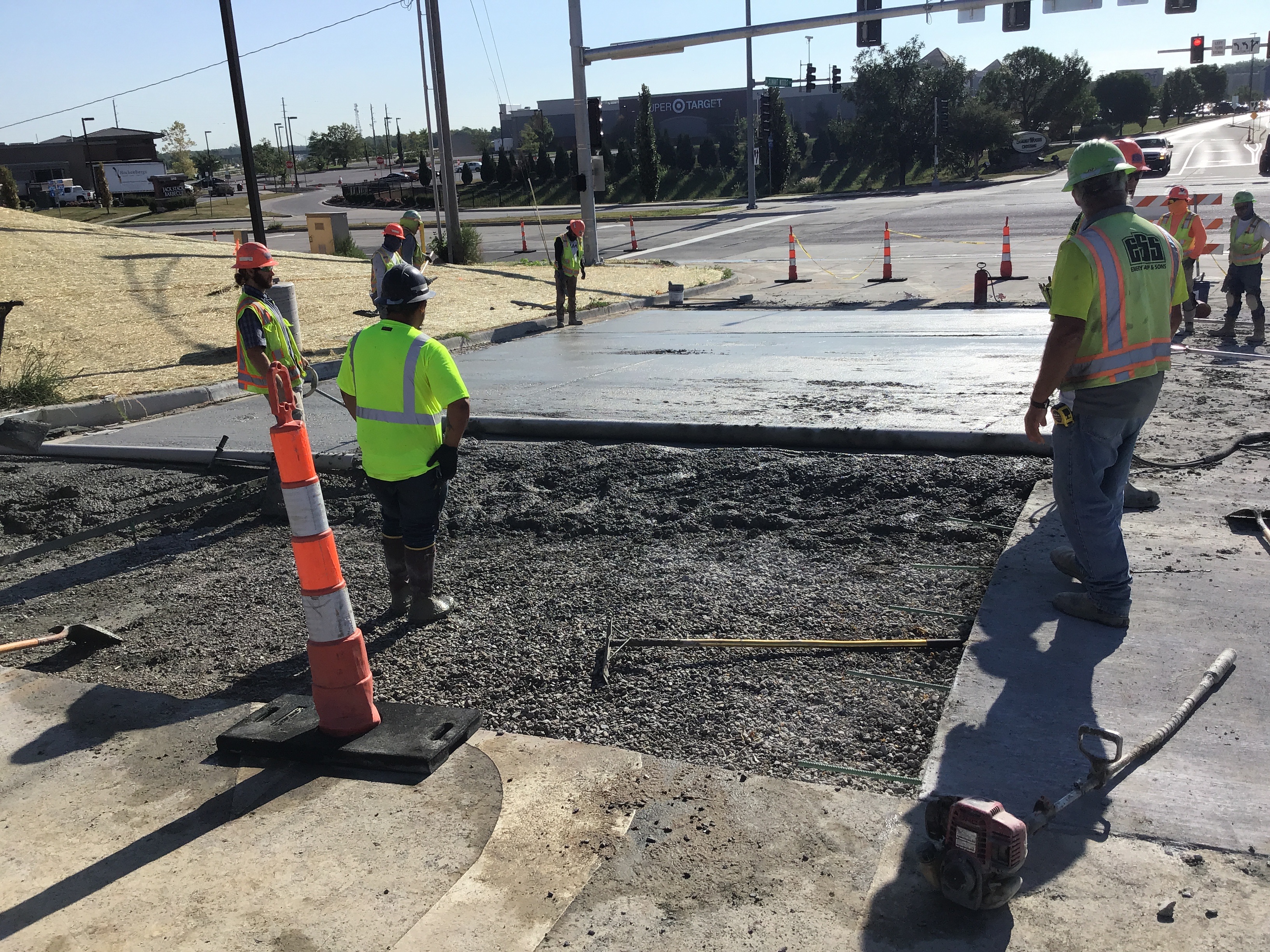

8/27/20 Thursday 10:55AM Contractor (ESS) began to pourIng concrete street Summit Woods and Pryor RD. Testing done by CFS 6.2 on air 83 temperature & 4” slump. See pictures in documents. 8/27/20 Thursday 1:01PM Contractor will complete the North half of the street tomorrow.
Misc
Informational
08/28/2020
8/28/20 Friday 9:12AM Contractor (ESS) is pourIng the Northside of street to complete worker.
Street - Concrete Passed 09/04/2020
Misc
Informational
08/27/2020
8/27/20 Thursday 10:55AM Contractor (ESS) began to pourIng concrete street Summit Woods and Pryor RD. Testing done by CFS 6.2 on air 83 temperature & 4” slump. See pictures in documents. 8/27/20 Thursday 1:01PM Contractor will complete the North half of the street tomorrow.
Misc
Informational
08/28/2020
8/28/20 Friday 9:12AM Contractor (ESS) is pourIng the Northside of street to complete work.
Street - Concrete Passed 09/04/2020
Misc
Informational
08/27/2020
8/27/20 Thursday 10:55AM Contractor (ESS) began to pourIng concrete street Summit Woods and Pryor RD. Testing done by CFS 6.2 on air 83 temperature & 4” slump. See pictures in documents. 8/27/20 Thursday 1:01PM Contractor will complete the North half of the street tomorrow.
Street - Concrete Passed 09/04/2020
Misc
Informational
08/27/2020
8/27/20 Thursday 10:55AM Contractor (ESS) began to pourIng concrete street Summit Woods and Pryor RD. Testing done by CFS 6.2 on air 83 temperature & 4” slump. See pictures in documents.
Street - Surface Course Passed 09/04/2020
Misc
Informational
08/26/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
08/26/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
08/26/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor. 6-28-20 11:33am They are laying surface asphalt on Private Rd A. They left a text message with John DiMauro at 8:45pm 6-27-20 saying that they were working today. 12:30pm They are using Type 3 recycled. They have completed Private Rd A and are now working on Private Rd B laying surface. Tempature of the asphalt out of the truck is 265 degrees. 3:25pm One more truck and they will have Private Rd. B complete. 4:08pm They have completed the private roads. 8-24-20 2:39pm ESS are tearing out the asphalt on Private road A to replace with concrete. 8-25-20 10:36am ESS has the asphalt removed and Geogrid installed. They are laying base rock now. 8-26-20 9:40am ESS have laid all of the base rock and are rolling it out. They will start setting up to pour on 8-27-20.
Street - Surface Course Passed 09/04/2020
Misc
Informational
08/25/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
08/25/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
08/25/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor. 6-28-20 11:33am They are laying surface asphalt on Private Rd A. They left a text message with John DiMauro at 8:45pm 6-27-20 saying that they were working today. 12:30pm They are using Type 3 recycled. They have completed Private Rd A and are now working on Private Rd B laying surface. Tempature of the asphalt out of the truck is 265 degrees. 3:25pm One more truck and they will have Private Rd. B complete. 4:08pm They have completed the private roads. 8-24-20 2:39pm ESS are tearing out the asphalt on Private road A to replace with concrete. 8-25-20 10:36am ESS has the asphalt removed and Geogrid installed. They are laying base rock now. 8-26-20 9:40am ESS have laid all of the base rock and are rolling it out. They will start setting up to pour on 8-27-20.
Street - Surface Course Passed 8/25/2020 8/25/2020 09/04/2020
Misc
Informational
08/24/2020
3-30-20 1:25pm They are setting up to put surface on private road A. They are starting at Lowenstein and working to private road C. They are using recycled type 3 for surface. The plans say type 3 for surface. 2:36pm They are done with surface on A road up to private road C. They are now setting up to surface the park.
Misc
Informational
08/24/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives.
Misc
Informational
08/24/2020
3-31-20 7:44am They layed surface on private road B. They still need to surface the drives. 6-11-20 9:10am Metro Asphalt are laying surface on Private road C. 2:01pm Metro is done with surface on Private road C. They are working on the turn lanes on Pryor. 6-28-20 11:33am They are laying surface asphalt on Private Rd A. They left a text message with John DiMauro at 8:45pm 6-27-20 saying that they were working today. 12:30pm They are using Type 3 recycled. They have completed Private Rd A and are now working on Private Rd B laying surface. Tempature of the asphalt out of the truck is 265 degrees. 3:25pm One more truck and they will have Private Rd. B complete. 4:08pm They have completed the private roads. 8-24-20 2:39pm ESS are tearing out the asphalt on Private road A to replace with concrete. 8-25-20 10:36am ESS has the asphalt removed and Geogrid installed. They are laying base rock now.
Driveway Inspection Passed 09/04/2020
Misc
Informational
06/11/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good.
Misc
Informational
06/11/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/11/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete.
Misc
Informational
06/11/2020
6-9-20 8:07am ESS is setting up to pour the drive into private Rd A. The base is good with a correction to be made on the north side of the drive. They will cut the base deeper and add more concrete. 2:34pm They have poured half of the drive and have set forms for the other half.6-11-20 7:57am ESS are pouring the rest of the drive at Summit Woods and Pryor.
Water Line - Construction Inspection Passed 09/04/2020
Misc
Informational
12/17/2019
11-20-19 11:06AM Rudy’s crew are working on the east side of Pryor for the boar. Matt’s crew are installing water line on the north east side of the site. They have approximately 140ft installed. They will be down to Pryor Rd. At the end of the day.
Misc
Informational
12/17/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/17/2019
11-21-19 10:16am They are prepping pipe to install under Pryor rd after the boar is complete.
Misc
Informational
12/17/2019
11-22-19 They have set the vault by Pryor and have ran all the water line under Pryor for the tie in. They made a correction on a valve that was going to be in the curb line.
Misc
Informational
12/17/2019
11-25-19 8:11am They are digging out to installing water line coming out of the vault at Pryor rd. 10:34am They have everything tied in. They will be pouring kickers at 3pm today.
Misc
Informational
12/17/2019
Joe Starlin 11/20/2019 6:42 AM They started on the water line on the north side of the site running along the road that leads to Pryor.
Misc
Informational
12/17/2019
11-19-19 They are laying out water line to install running east and west at the north end of the site. Matt is the Forman in charge of the work today.
Misc
Informational
12/17/2019
11-11-19 They placed approximately 50ft of water line across the road on the north end of the site. They will need to have compaction test done.
Misc
Informational
12/17/2019
11-13-19 9:34am They installled approximately 220ft of water Line yesterday. Today they have 20ft installed and are waiting on the surveyors. They will be pouring kickers around 12pm. They have approximately 200ft of water line installed and are working on hydrants.
Misc
Informational
12/17/2019
11-14-19 8:01am They are currently working on placing water line in on the west side of the appartment site. 10:01am They are installling there 17th stick of water line. 4:11pm They have installed over 1000ft of water line.
Misc
Informational
12/17/2019
11-18-19 10:25am They are digging on the east side of Pryor rd to get to the water main. They plan on boarding under Pryor tomorrow 11-19-19. 2:30pm They are on the west side of Pryor digging to the water main.
Misc
Informational
12/17/2019
11-26-19 1:47pm They are prepping for the water tie in tonight at 11pm.
Misc
Informational
12/17/2019
11-27-19 We shut the valves for the water main at 11pm. There were two more fire hydrants effected and Jack Stack BBQ.12:17am They have cut out the section of water main and are now working on placing in the tee. They have bleach and granule chlorine on site to be used. 1:52am The tie-in is complete and we are flushing the main. 2:40am The main is flushed and the crew are picking up there equipment and covering the hole.
Misc
Informational
12/17/2019
12-2-19 8:29am Rudys crew are digging out to install construction taps for water testing. They have found out the water has beeen turned on and we need to make sure that the valve was not turned on at Pryor. This would flush are chlorine out that is in the pipe under Pryor.
Misc
Informational
12/17/2019
12-3-19 Rudy and his crew were prepping for the chlorine to go into the line. 10:57am The waterline is chlorinated.
Misc
Informational
12/17/2019
12-6-19 11:06am They have approximately 360ft of waterline installed running from the south end at Lowenstein heading north. They still need to install the vault at the south end.
Misc
Informational
12/17/2019
12-9-19 8:30am They are digging out for the vault on the south end of the site. We are at the north end of the site on the corner of the A road to flush the chlorine out of the waterline. The waterline is flushed coming from Lowenstein and we are flushing from Pryor now. The water line is flushed and we will start pulling samples on 12-10-19. They now have the vault set and waterline ran to it. They are pouring thrust blocks and will cover them with blankets.
Misc
Informational
12/17/2019
12-10-19 They are working on the waterline on the south end of the site.
Misc
Informational
12/17/2019
12-11-19 2:17pm They have 10 sticks of waterline installed and are busting rock. They are working on the south east side of the site. Rudys crew.
Misc
Informational
12/17/2019
12-12-19 They have set the tee that will feed lot 10. They will be pouring thrust blocks later today. 1:40pm They are digging across the road to install a Fire hydrant. 2:55pm They have set the hydrant by storm box L1. They have poured all thrust blocks.
Misc
Informational
12/17/2019
12-17-19 1:19pm They flushed the chlorine out of the waterline running north to south. We will be pulling samples tomorrow.
Misc
Informational
01/09/2020
1-9-20 10:44am They have set two vaults on the south east corner of the apartment building. Vault LS-BFG-01, LS-MV4-01. They are now running the waterlines across the road 8” and 4”. They are adding the powder chlorine as they go. CFS will be doing compaction testing for the road crossing.
Water - Material Verification Passed 09/04/2020
Documents & Images
Date Uploaded File Type Document Name
08/14/2019 Receipt Receipt for transaction: 2019-005587
08/16/2019 Letter DE-Permit
08/16/2019 sign permit 2191
11/11/2019 Letter INSPECTION SUMMARY
11/12/2019 Letter INSPECTION SUMMARY
11/14/2019 Water line
11/14/2019 Water line0
11/15/2019 Two wyes
11/15/2019 Wyes
11/16/2019 Sanitary service for appt
11/16/2019 Type 5 fill
11/22/2019 Vault
11/25/2019 Backflow preventer
11/27/2019 Water tie in tee
11/27/2019 Tie in
12/04/2019 Private road manhole repair
12/06/2019 Waterline private south end
12/16/2019 water sample swp
12/16/2019 water sample swp1
12/16/2019 water sample swp2
01/09/2020 Water valve
01/09/2020 Water line at intersection
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter DE-Daily Inspection Summary
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/11/2020 Letter INSPECTION SUMMARY
03/30/2020 Letter INSPECTION SUMMARY
03/30/2020 B road base
03/30/2020 Letter INSPECTION SUMMARY
03/30/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
04/29/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/04/2020 Letter INSPECTION SUMMARY
05/11/2020 Letter INSPECTION SUMMARY
05/21/2020 Letter INSPECTION SUMMARY
05/21/2020 Letter INSPECTION SUMMARY
05/27/2020 Letter INSPECTION SUMMARY
06/01/2020 Letter INSPECTION SUMMARY
06/01/2020 Letter INSPECTION SUMMARY
06/08/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
06/11/2020 Letter INSPECTION SUMMARY
06/11/2020 Letter INSPECTION SUMMARY
06/28/2020 Letter INSPECTION SUMMARY
07/08/2020 approved 8_9_19 SWP 7067-1INT RD1
07/08/2020 Letter INSPECTION SUMMARY
07/10/2020 Letter INSPECTION SUMMARY
07/13/2020 Letter INSPECTION SUMMARY
07/14/2020 Letter INSPECTION SUMMARY
07/20/2020 Letter INSPECTION SUMMARY
08/06/2020 Letter INSPECTION SUMMARY
08/24/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
08/27/2020 image.jpg
08/27/2020 image.jpg0
08/27/2020 image.jpg1
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 image.jpg2
08/27/2020 image.jpg3
08/27/2020 Letter INSPECTION SUMMARY
08/28/2020 image.jpg4
08/28/2020 Letter INSPECTION SUMMARY
08/28/2020 image.jpg5
08/28/2020 image.jpg6
08/28/2020 image.jpg7
08/28/2020 image.jpg8
08/28/2020 Letter INSPECTION SUMMARY
08/28/2020 Letter INSPECTION SUMMARY
09/03/2020 Letter INSPECTION SUMMARY
09/10/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
09/10/2020 Letter DE-Punch List
09/13/2020 Private Road 'A' West Asphalt Surface letter
03/01/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
