Permit Application Status

PRSUBD20191069


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20191069
Public Infrastructure
Final Acceptance
JCM DEVELOPMENT LLC
DEVELOPMENT COMPLETE
COBEY CREEK - ON-SITE SANITARY, STREET, STORM, MDP, ESC and Water
04/25/2019
05/21/2020
11/02/2024
08/24/2022
Locations
Contacts
JCM DEVELOPMENT LLC, Address:1314 SW MARKET ST
EARTHWORKS EXCAVATION, Address:19495 BELL ROAD, Phone:(660) 584-5020
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 04/25/2019 05/21/2020
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $6,646.38 $6,646.38 Paid Not payable online 04/25/2019
Storm Sewer Inspection Fee $12,412.14 $12,412.14 Paid Not payable online 08/01/2019
Paved Surface Inspection Fee $29,024.13 $29,024.13 Paid Not payable online 08/01/2019
Site Grading Fee $16,666.17 $16,666.17 Paid Not payable online 08/01/2019
Right of Way Permit Fee $80.00 $80.00 Paid Not payable online 08/01/2019
Water Insp Fee $9,456.42 $9,456.42 Paid 05/20/2020
Water Test Fee $1,600.00 $1,600.00 Paid 05/20/2020
Outstanding Fees Amount Paid Owing Date Paid
Not Ready Inspection Fee $75.00 $0.00 $75.00 Not Paid


$75.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Partial 08/04/2019
Misc
Informational
08/04/2019
MAY 28, 2019 @10:32AM Inspector did not speak to anyone with Earthworks Excavation. Inspector could see that at least 1 person from Earthworks was present and doing some clearing and grubbing.
Misc
Informational
08/04/2019
MAY 30, 2019 @ 3:15PM Earthworks Excavation crews were on site clearing and grubbing.
Misc
Informational
08/04/2019
JUNE 3, 2019 @10:30AM No crews on site.
Misc
Informational
08/04/2019
JUNE 5, 2019 @11:00AM Earthworks Excavation crew is on site clearing and grubbing.
Misc
Informational
08/04/2019
JUNE 6, 2019 @10:10AM No crews were on site.
Misc
Informational
08/04/2019
JUNE 11, 2019 @2:30 PM No crews were on site. Earthworks Excavating has been clearing and grubbing but not here today.
Misc
Informational
08/04/2019
JUNE 18, 2019 @11:00am Earthworks crews were on site grading and mowing.
Misc
Informational
08/04/2019
JUNE 24, 2019 11:45am Inspector spoke with Tim Trigg of Earthworks Excavation. Tim informed inspector that Earthworks crew would start digging this week.
Misc
Informational
08/04/2019
JUNE 25, 2019 @ 9:30AM No crews working on site. Heavy Machinary has been brought on site.
Misc
Informational
08/04/2019
JULY 1, 2019 @10:30AM Earthworks crew was on site. Starting stubb is located in wrong place. Inspector told crew to take pics and submit actual stubb location to their engineers.
Misc
Informational
08/04/2019
JULY 9, 2019 Inspector made site visit to see where crew was with Man hole that is in wrong location. Crews informed Inspector that they were going to core I existing Man hole and start. Inspector informed crew not to do that until their engineers and the City’s engineers worked through their process to correct the problem
Misc
Informational
08/04/2019
JULY 10, 2019 Earthworks Crews have started excavating their first line. Crew and Inspector still waiting on Man hole decision.
Misc
Informational
08/04/2019
JULY 11, 2019 Inspector spoke with Jeff Tyler of Earthworks. Jeff was hoping to core tomorrow July 12, 2019. Inspector spoke with Development Engineer Kent Monter and he said we were still waiting on Engineer Kevin Sterrett to submit revised CAD plans before starting.
Sanitary Sewer Construction Inspection Partial 08/04/2019
Misc
Informational
08/04/2019

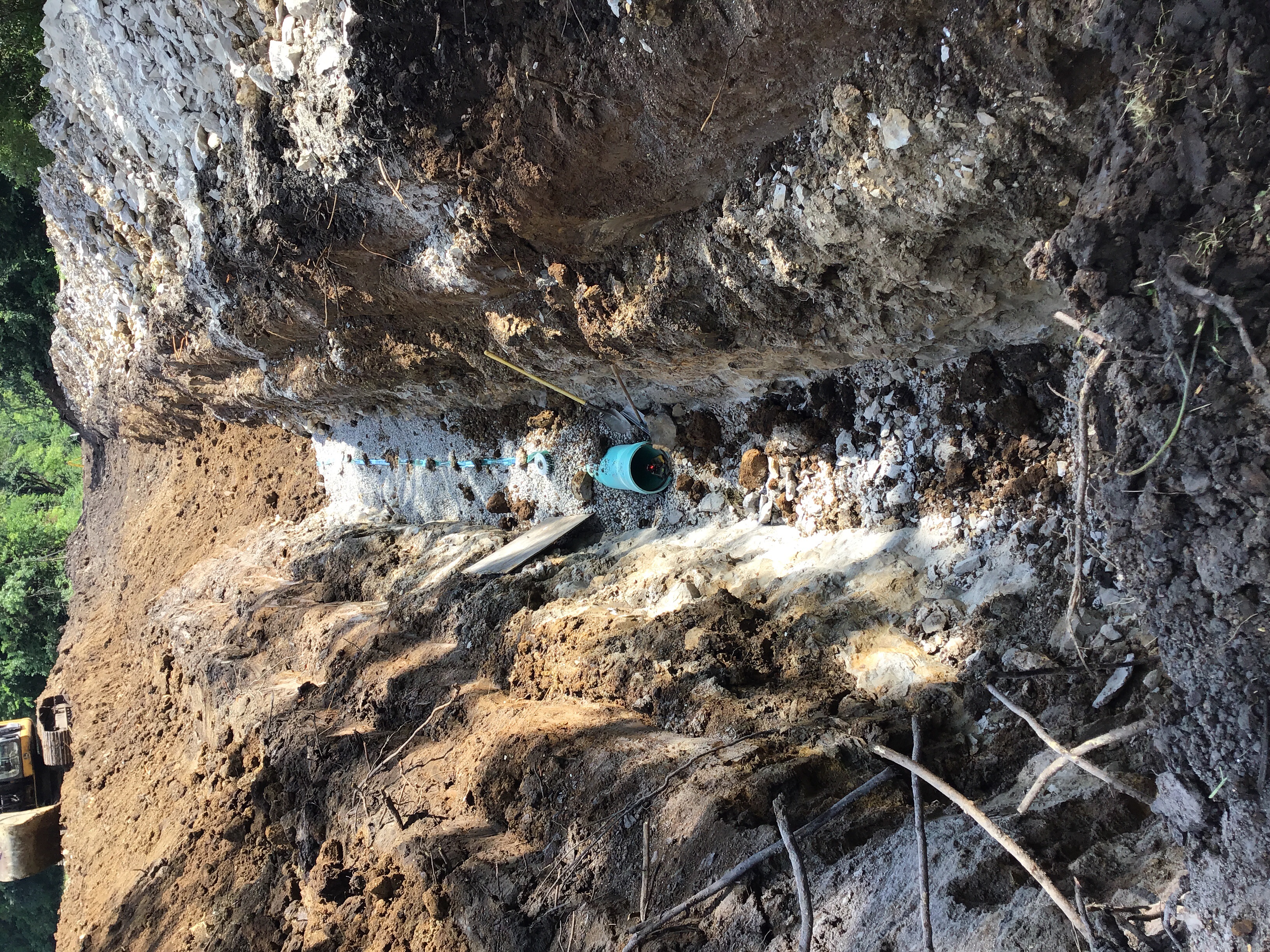

JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/04/2019
JULY 16, 2019 Inspector took pics of plugged Manhole (Inside and Out). Crew also has 1 stick of Sanitary in.
Misc
Informational
08/04/2019
JULY 17, 2019 Earthworks Crew has started installing Sanitary Line A.
Misc
Informational
08/04/2019
JULY 18, 2019 Earthworks crew has installed Sanitary Line A up to Manhole A1. Crew also has 31’ Concrete Encasement rebar formed for inspector to see.
Misc
Informational
08/04/2019

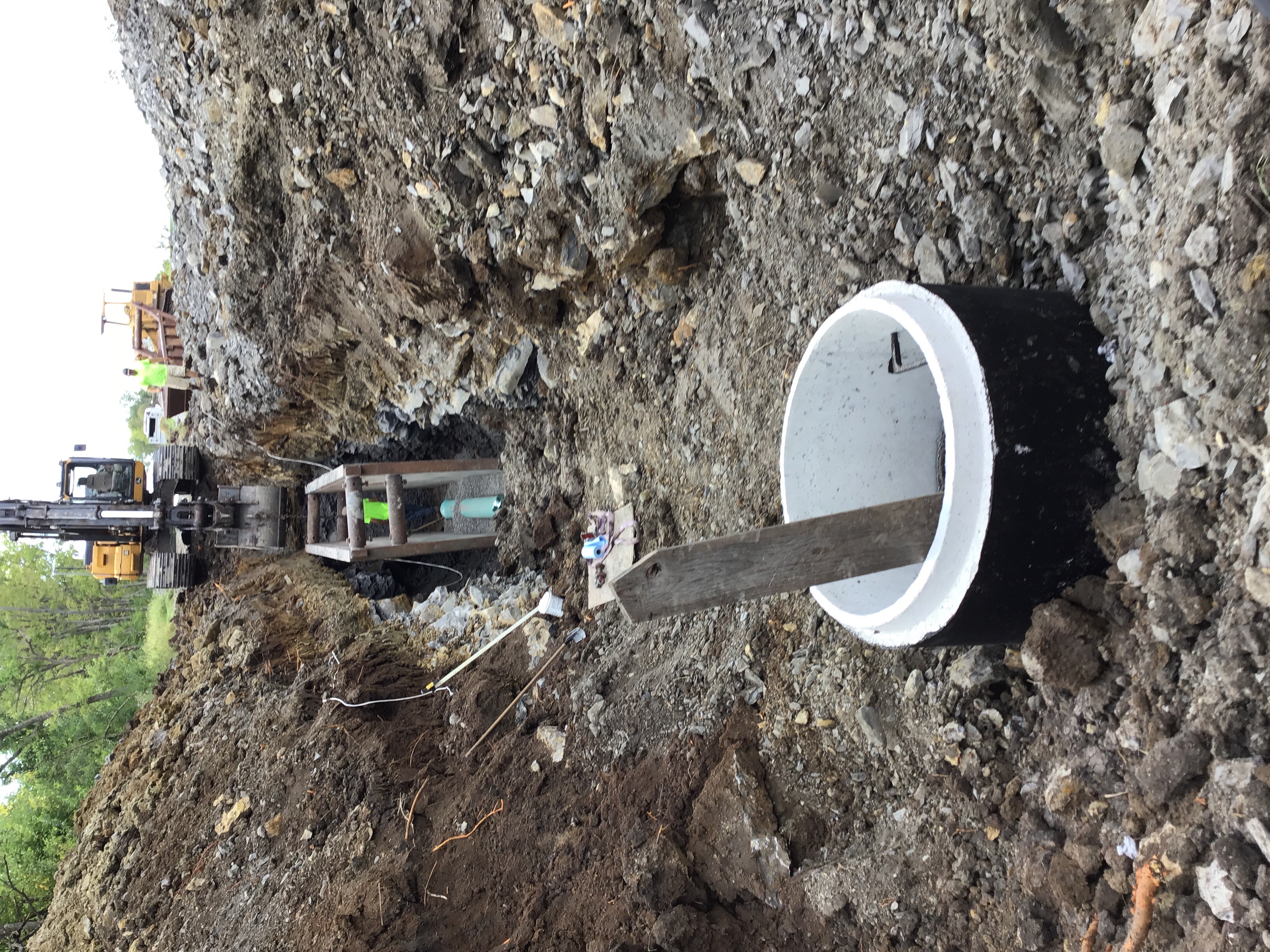

JULY 19, 2019 Earthworks Crew continuing Sanitary Line A- Exisiting to A1. Crew has poured concrete encasement and has also cover Sanitary with the proper amount of clean gravel.
Misc
Informational
08/04/2019
JULY 24, 2019 Earthworks Excavation crew continuing installing Sanitary Line A from MH A1 to MH A2
Misc
Informational
08/04/2019
JULY 25, 2019 Earthworks Excavation has installed Sanitary Line A from MH A1 to MH A2.
Misc
Informational
08/04/2019
JULY 26, 2019 Earthworks Excavation crew is continuing installing Sanitary Line A from MH A2 to MH A3
Misc
Informational
08/04/2019
JULY 29, 2019 Earthworks Excavation is continuing installing Sanitary Line A from MH A2 to MH A3 and backfilling.
Misc
Informational
08/04/2019
JULY 30, 2019 Earthworks Excavation is continuing to install Sanitary Line A from MH A2 to MH A3.
Misc
Informational
08/04/2019
JULY 31, 2019 Earthworks Excavation has MH 3 set on Sanitary Line A. Crew will start to excavate from MH 3 to MH4 tomorrow.
Misc
Informational
08/04/2019
AUGUST 1, 2019 Earthworks Excavation has set MH A3 on Sanitary Line A and are continuing to backfill, dig and install pipe from MH A3 to MH A4
Sanitary Sewer Construction Inspection Partial 08/05/2019
Misc
Informational
08/04/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/05/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Sanitary Sewer Construction Inspection Partial 08/06/2019
Misc
Informational
08/05/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/05/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/06/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Sanitary Sewer Construction Inspection Partial 08/09/2019
Misc
Informational
08/06/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/06/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/06/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/09/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Sanitary Sewer Construction Inspection Partial 08/12/2019
Misc
Informational
08/09/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/09/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/09/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/09/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/12/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Sanitary Sewer Construction Inspection Partial 08/12/2019
Misc
Informational
08/12/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/12/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/12/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/12/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/12/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/12/2019

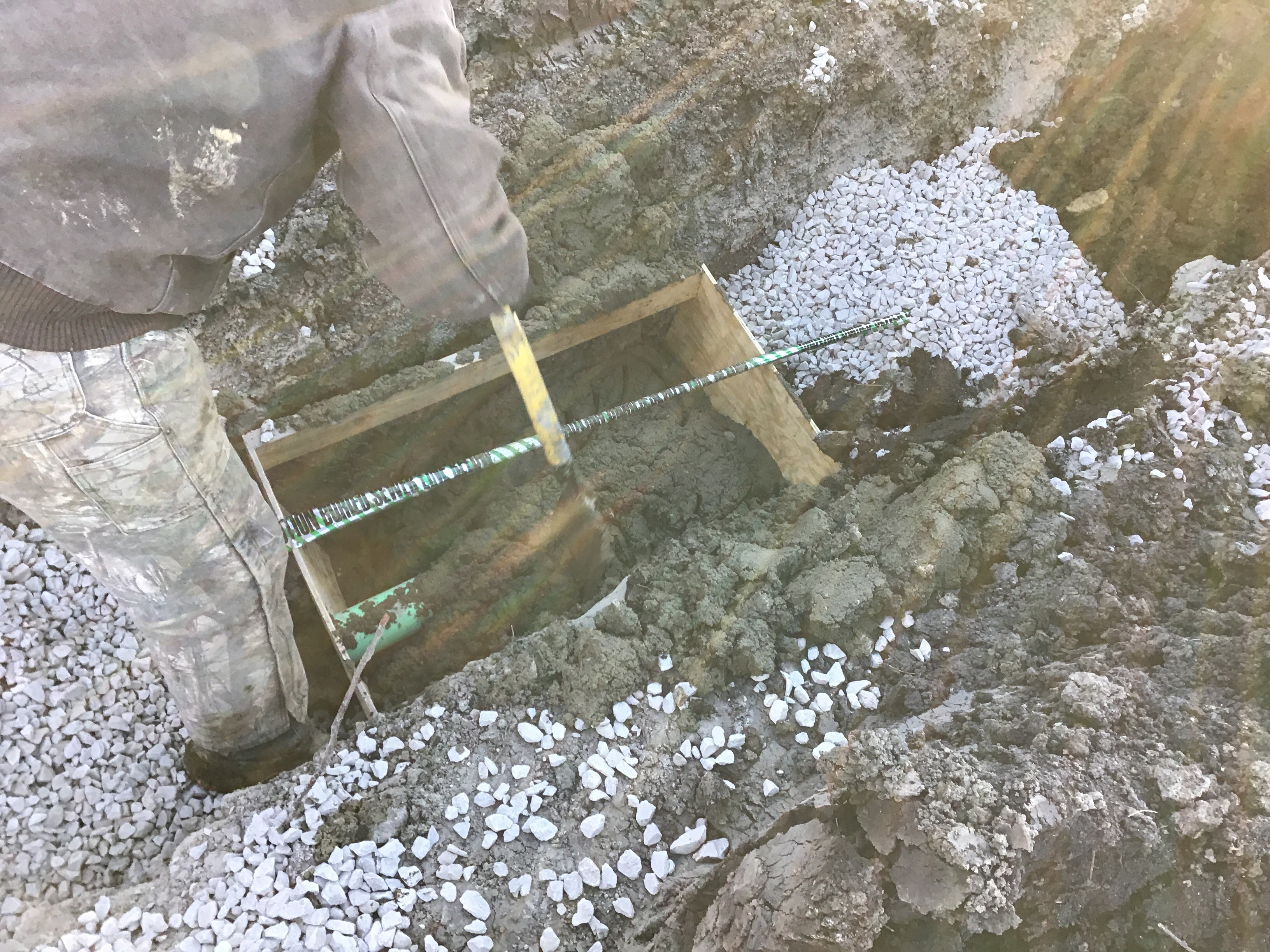

AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Sanitary Sewer Construction Inspection Partial 08/13/2019
Misc
Informational
08/12/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/12/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/12/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/12/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/12/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/12/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/13/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Sanitary Sewer Construction Inspection Partial 08/14/2019
Misc
Informational
08/13/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/13/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/13/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/13/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/13/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/13/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/13/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
08/14/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Sanitary Sewer Construction Inspection Partial 08/15/2019
Misc
Informational
08/14/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/14/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/14/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/14/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/14/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/14/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/14/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
08/14/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
08/15/2019

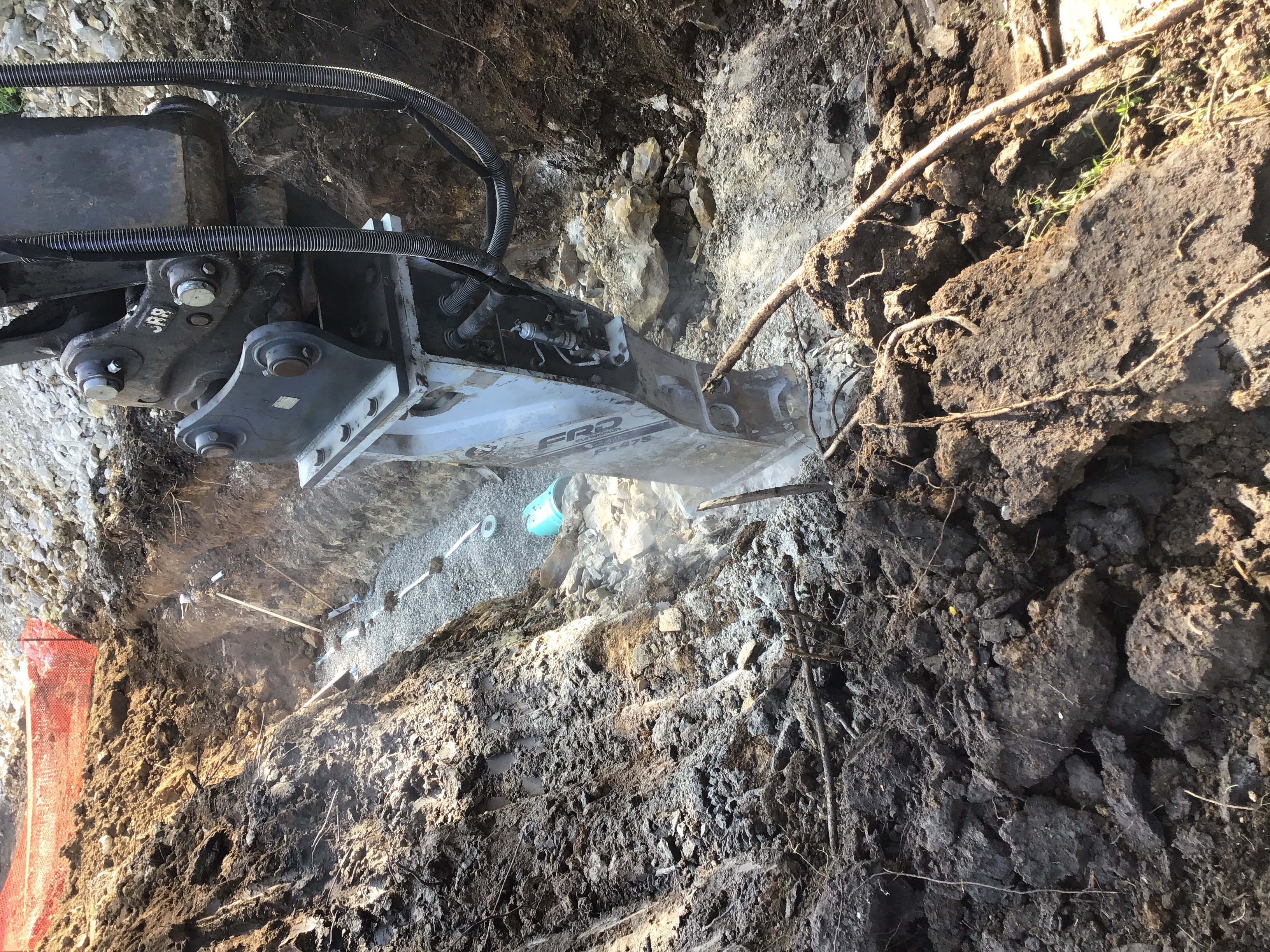

AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Grading/Excavation/Fill Inspection Partial 08/20/2019
Misc
Informational
08/20/2019

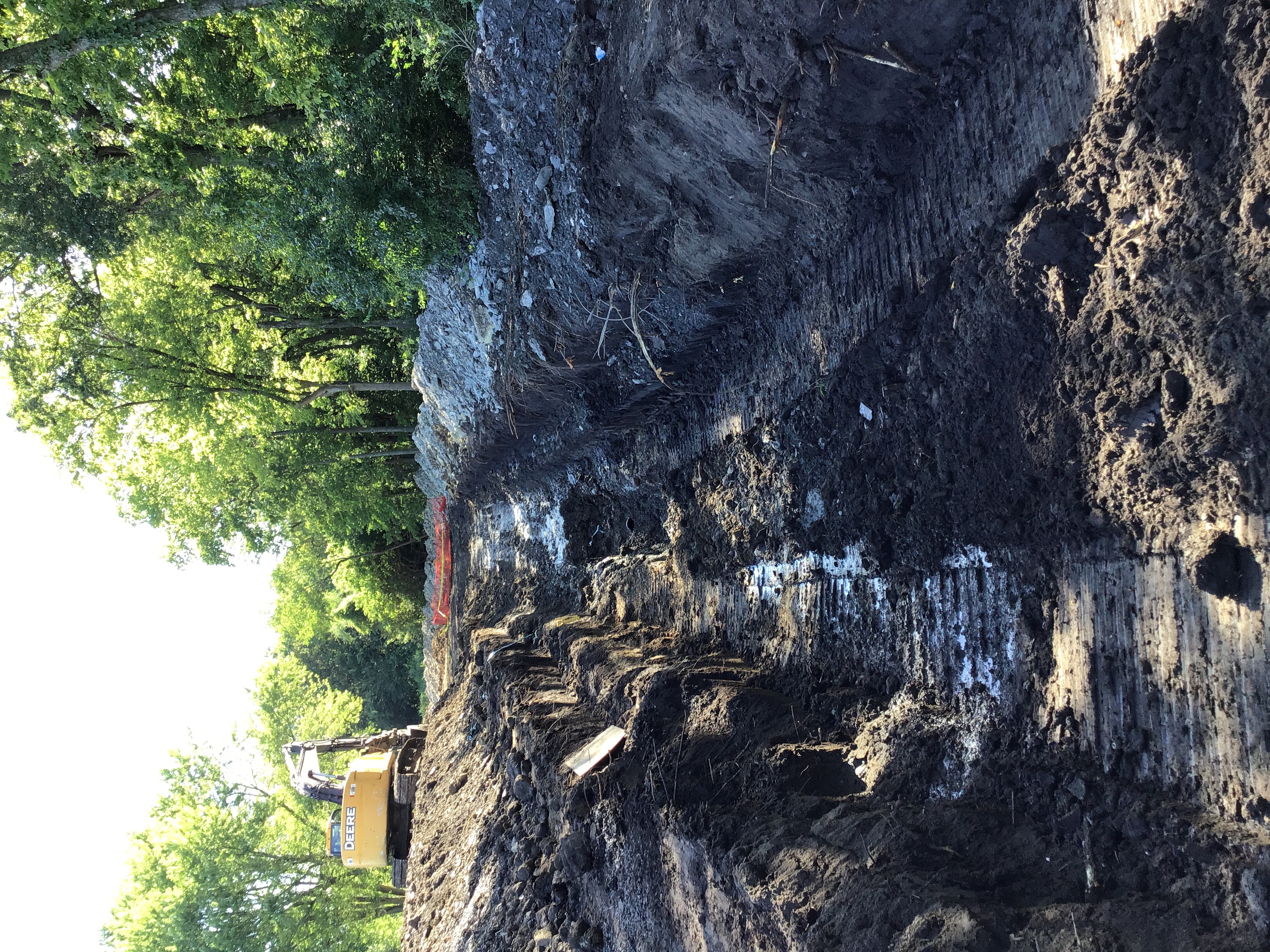

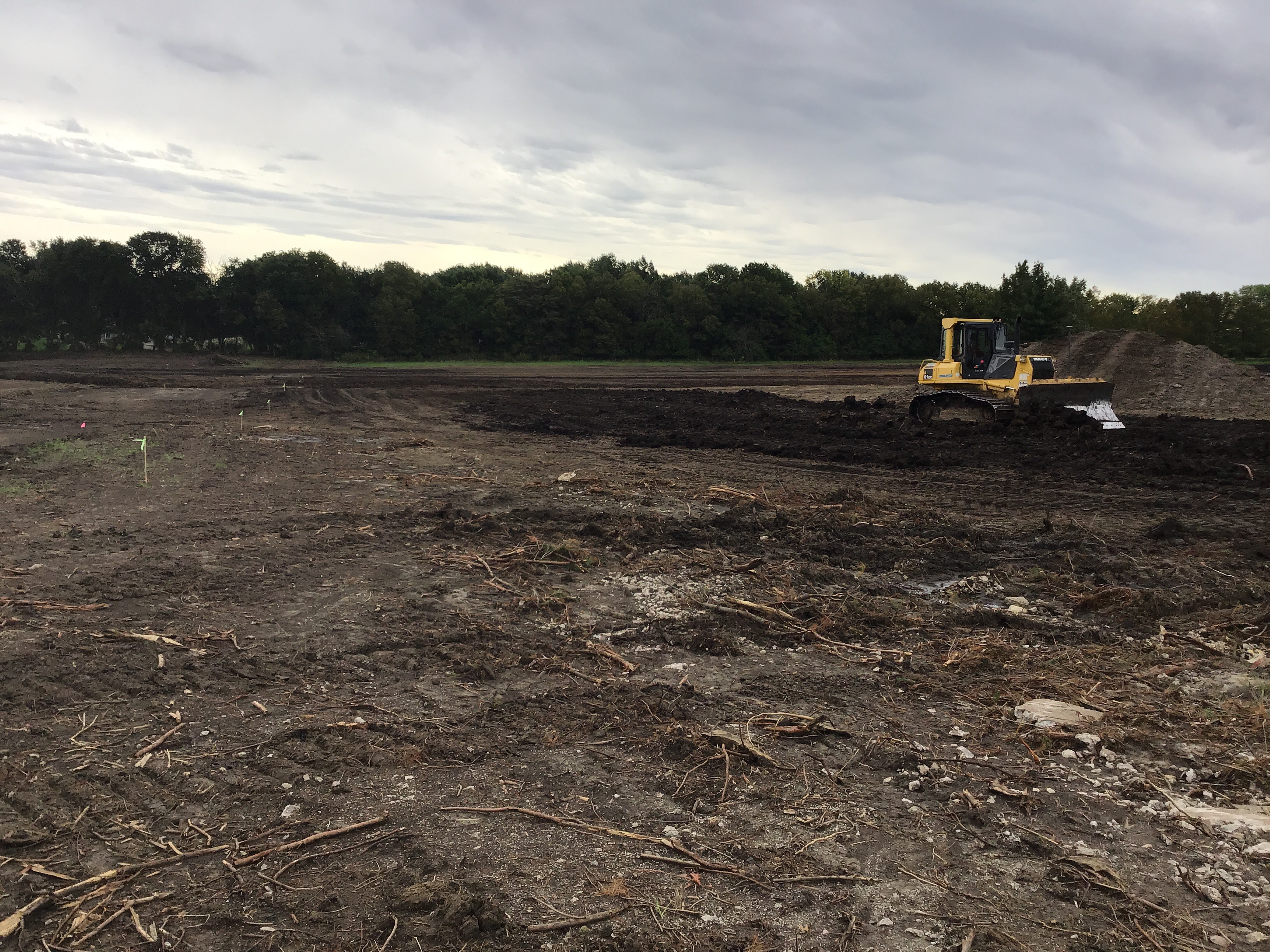

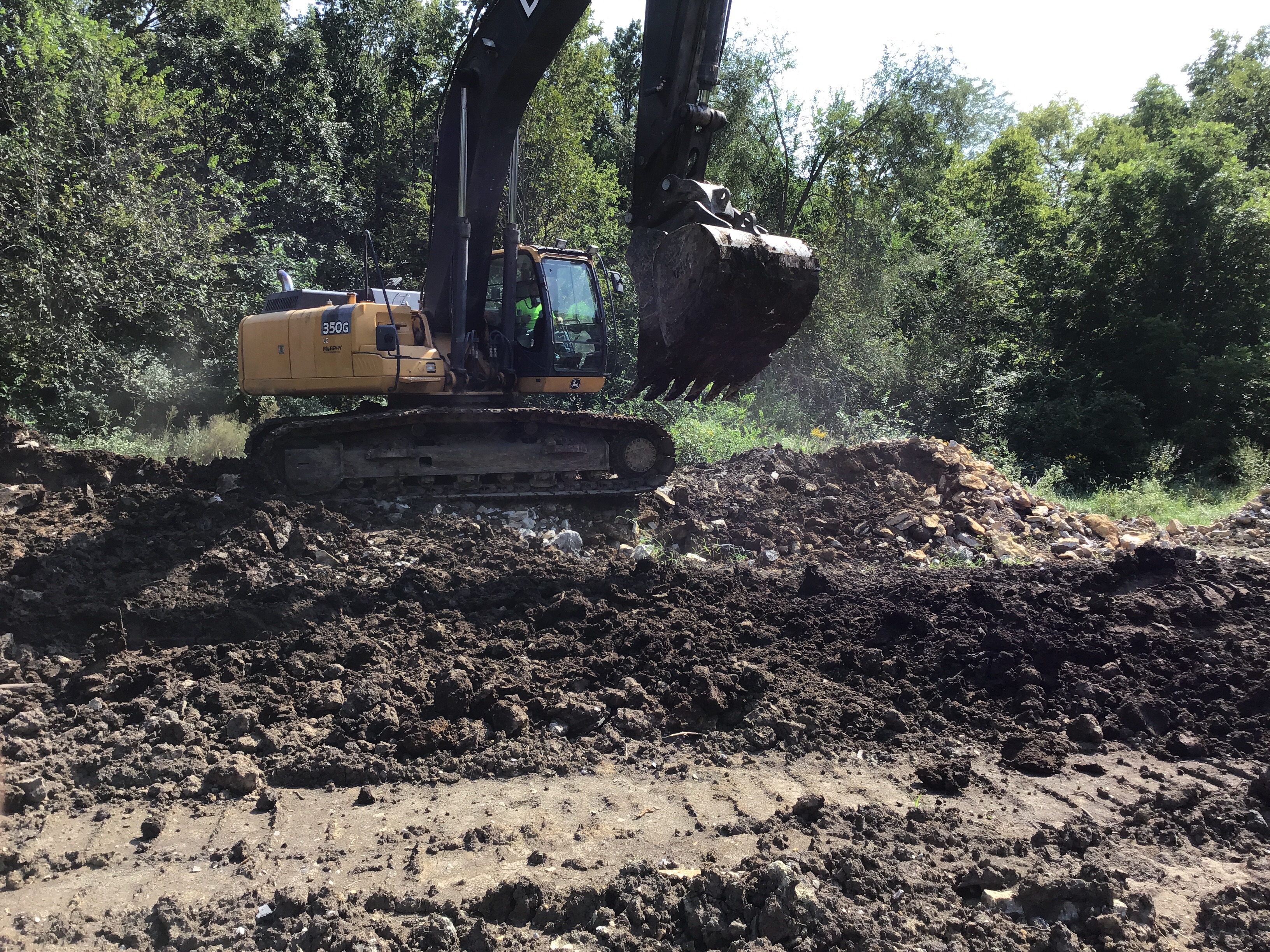

AUGUST 20, 2019 Earthworks Excavating has started excavating and grading detention pond on east side of site.
Misc
Informational
08/28/2019
AUGUST 28, 2019 Earthworks Excavation crew continues to grade and stake detention pond on east side of project. Crew leader with Earthworks Excavation Jeff asked numerous questions on cutting and back filling. Jeff also said he would be trying to get a detailed solution to fix the existing stubb where crew starting hooking up.
Misc
Informational
10/09/2019
OCTOBER 8, 2019 Macy Construction continues to move dirt, and excavate trees on the onsite portion of the project. Streets have been staked.
Sanitary Sewer Construction Inspection Partial 08/20/2019
Misc
Informational
08/15/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/15/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/15/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/15/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/15/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/15/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/15/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
08/15/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
08/15/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
08/20/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Sanitary Sewer Construction Inspection Partial 08/28/2019
Misc
Informational
08/20/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/20/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/20/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/20/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/20/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/20/2019

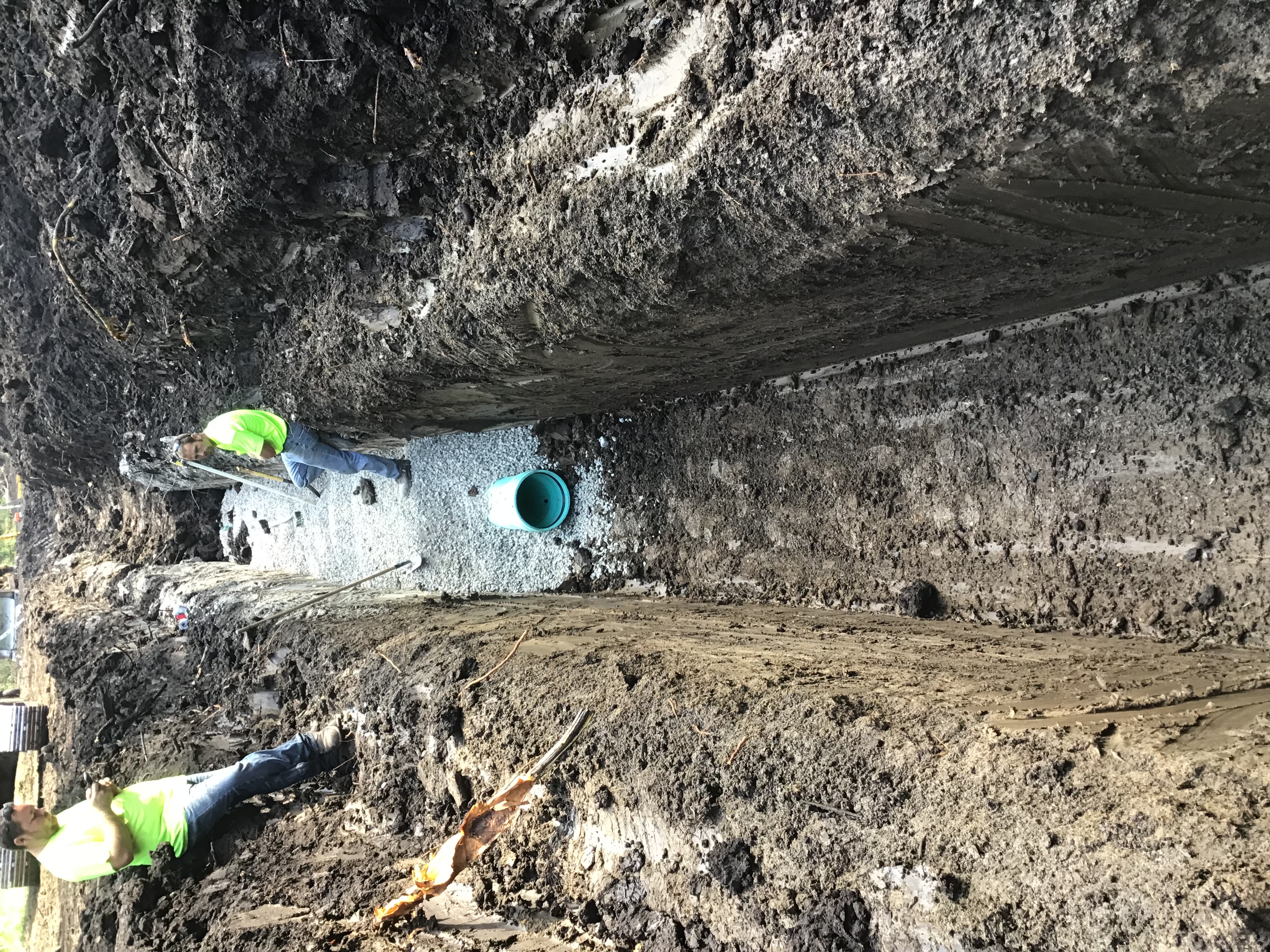

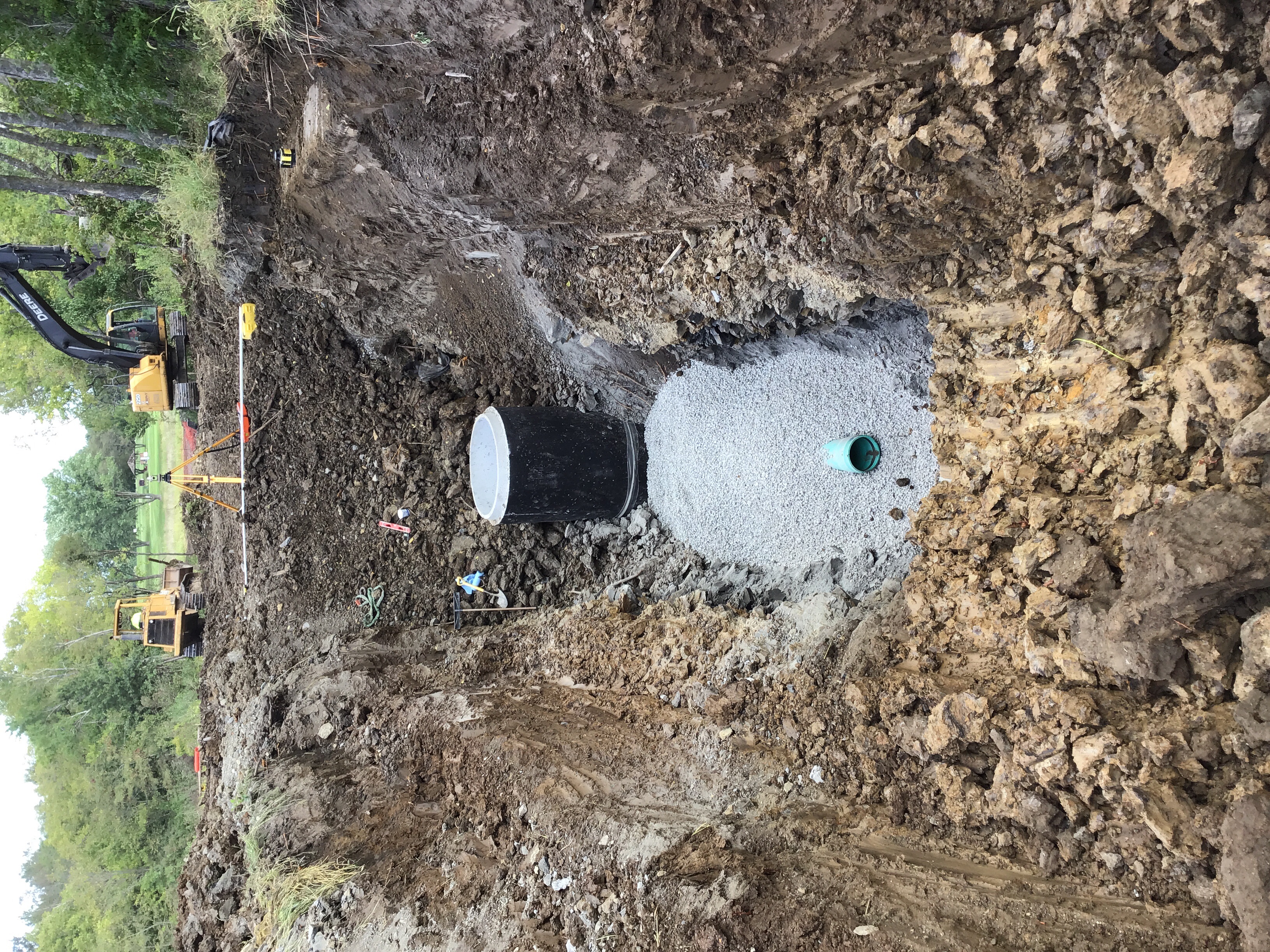

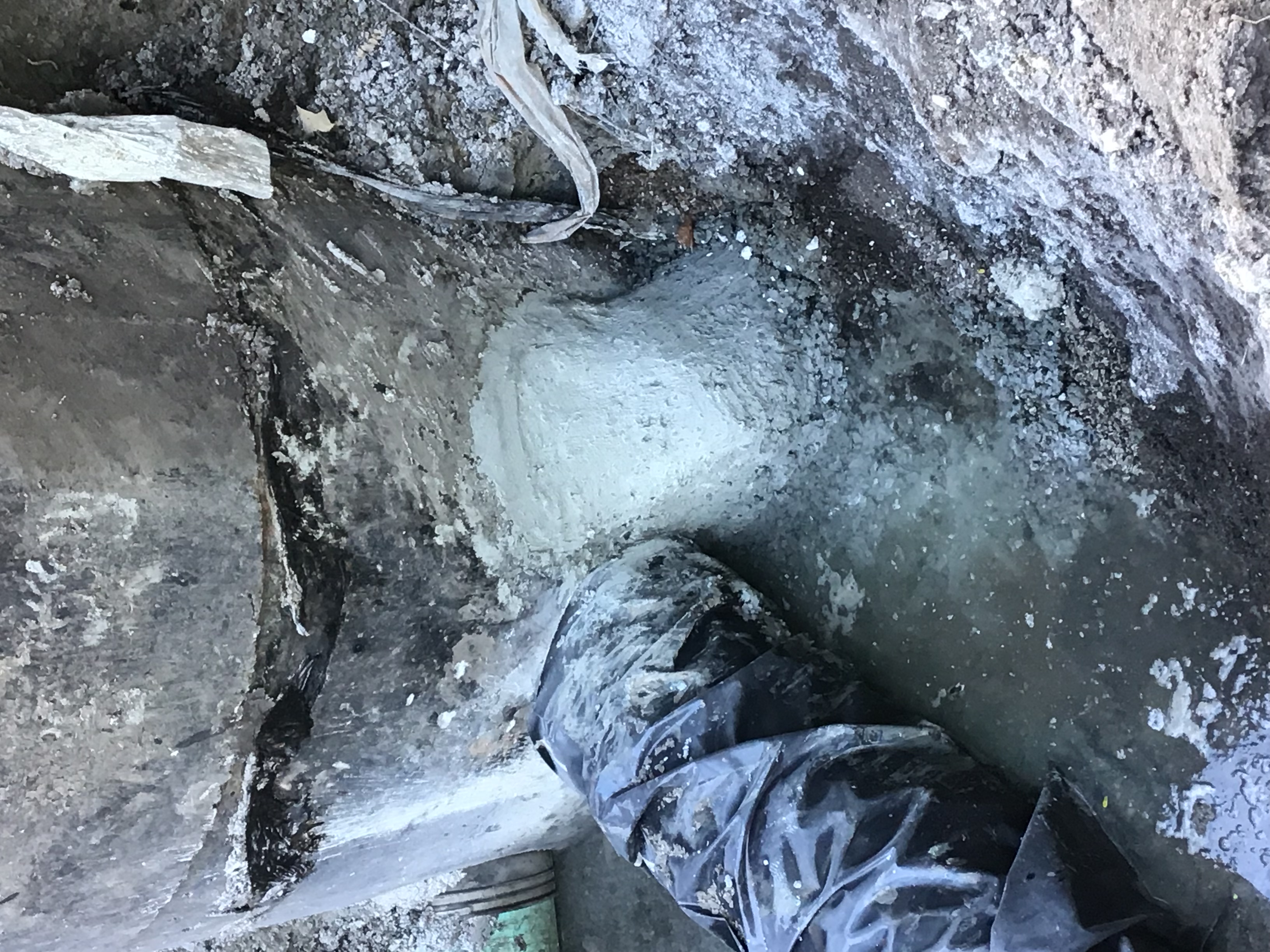

AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/20/2019

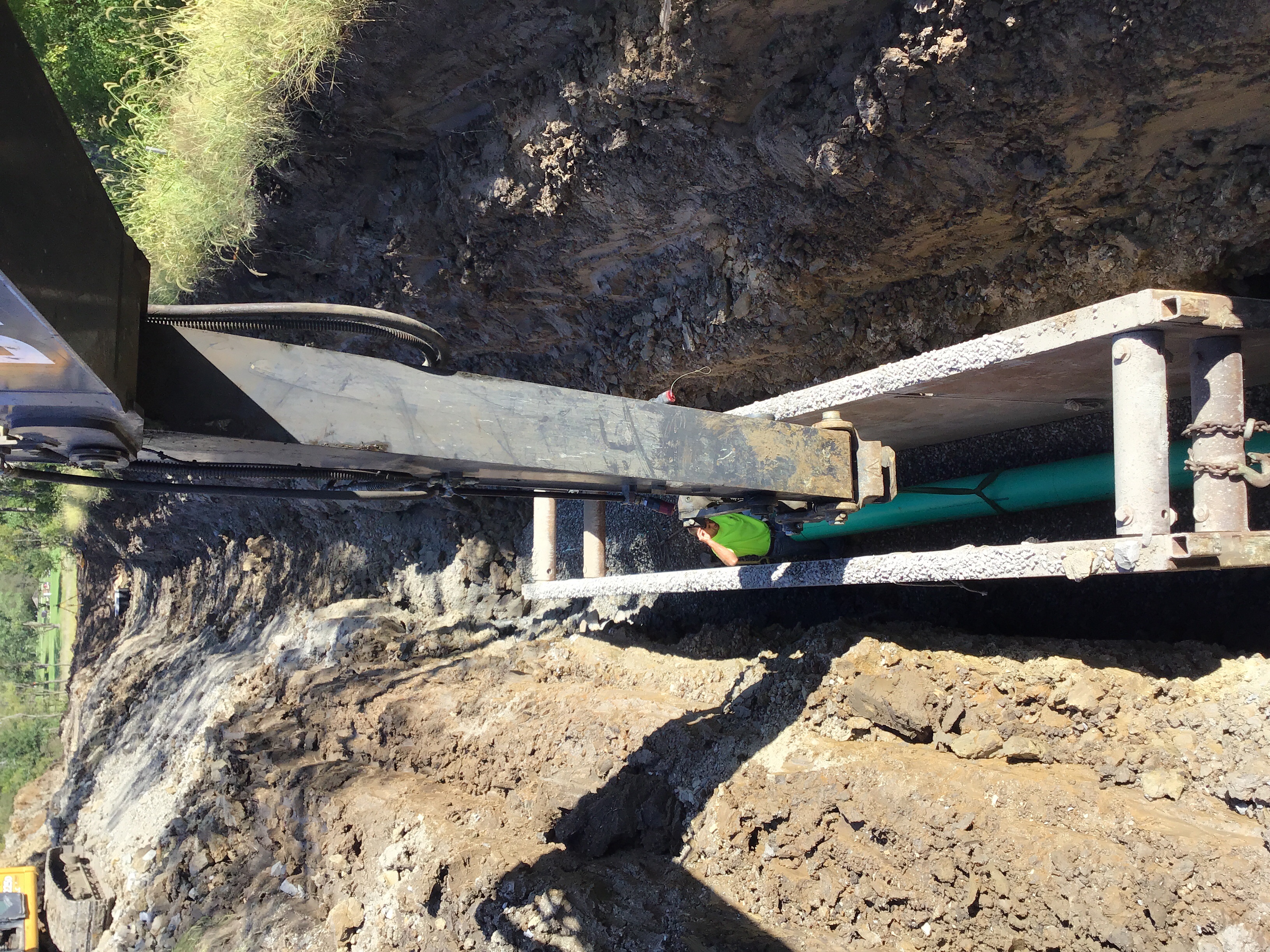

AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
08/20/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
08/20/2019

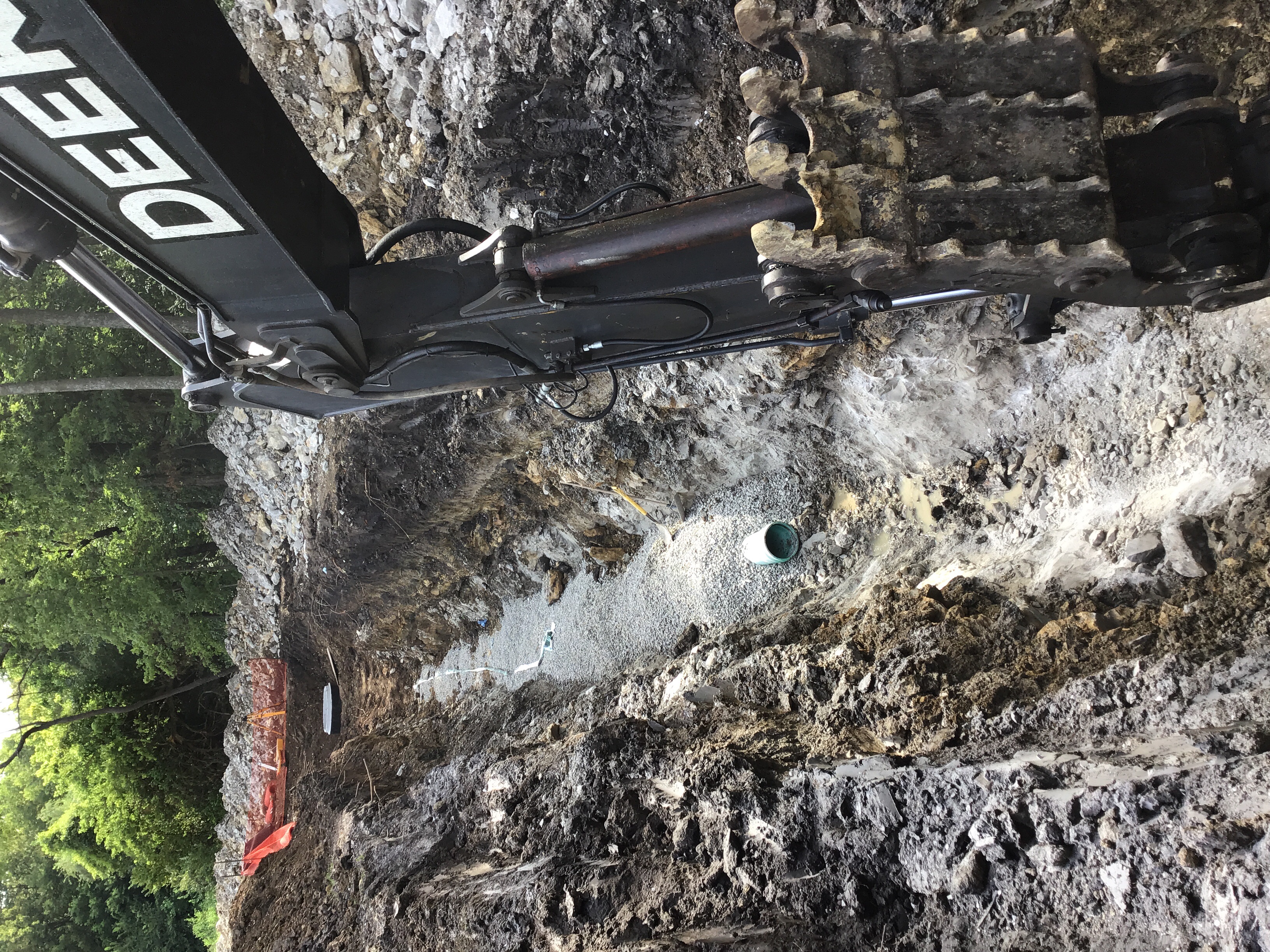

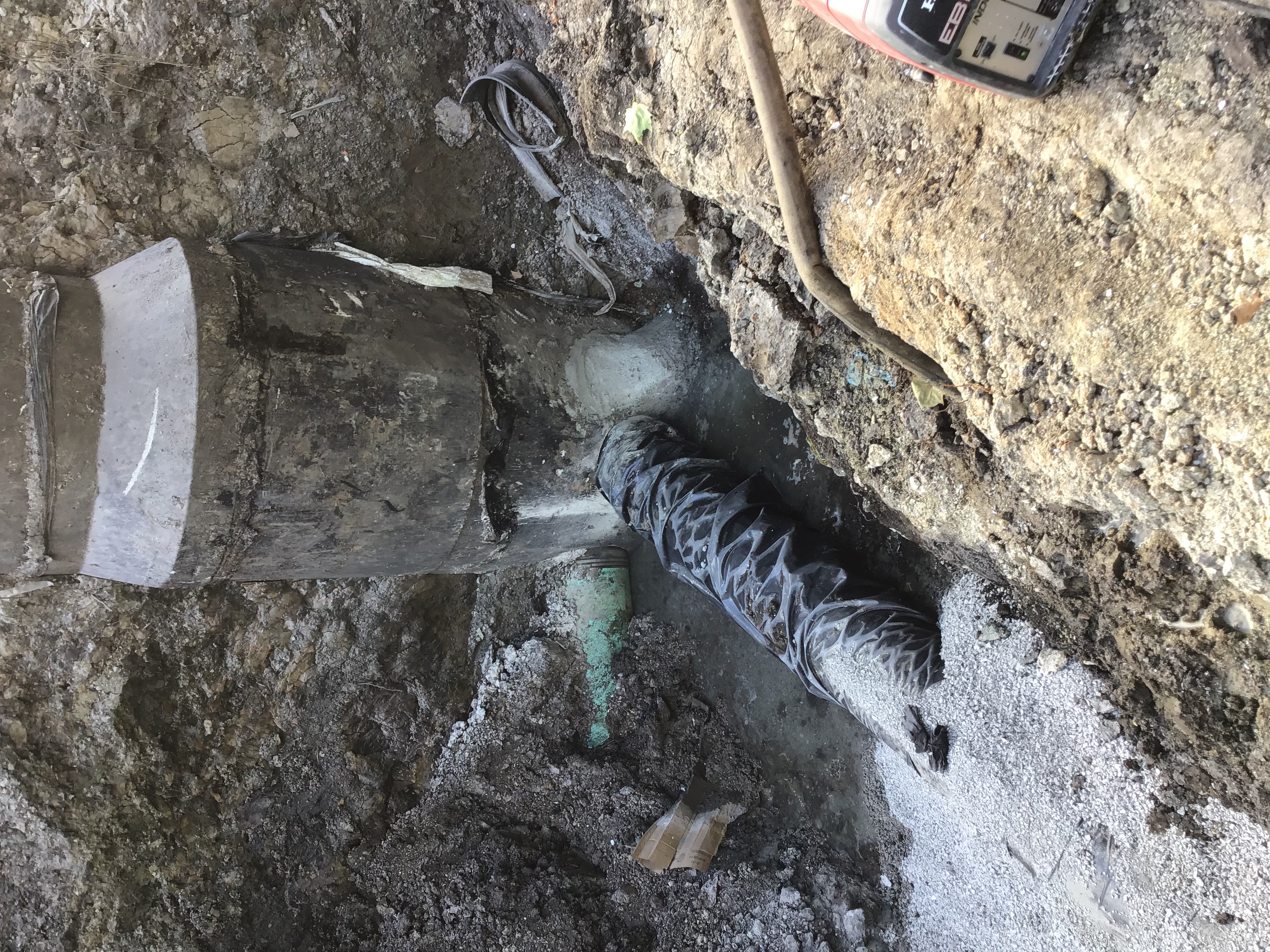

AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
08/20/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Sanitary Sewer Construction Inspection Partial 09/06/2019
Misc
Informational
08/28/2019

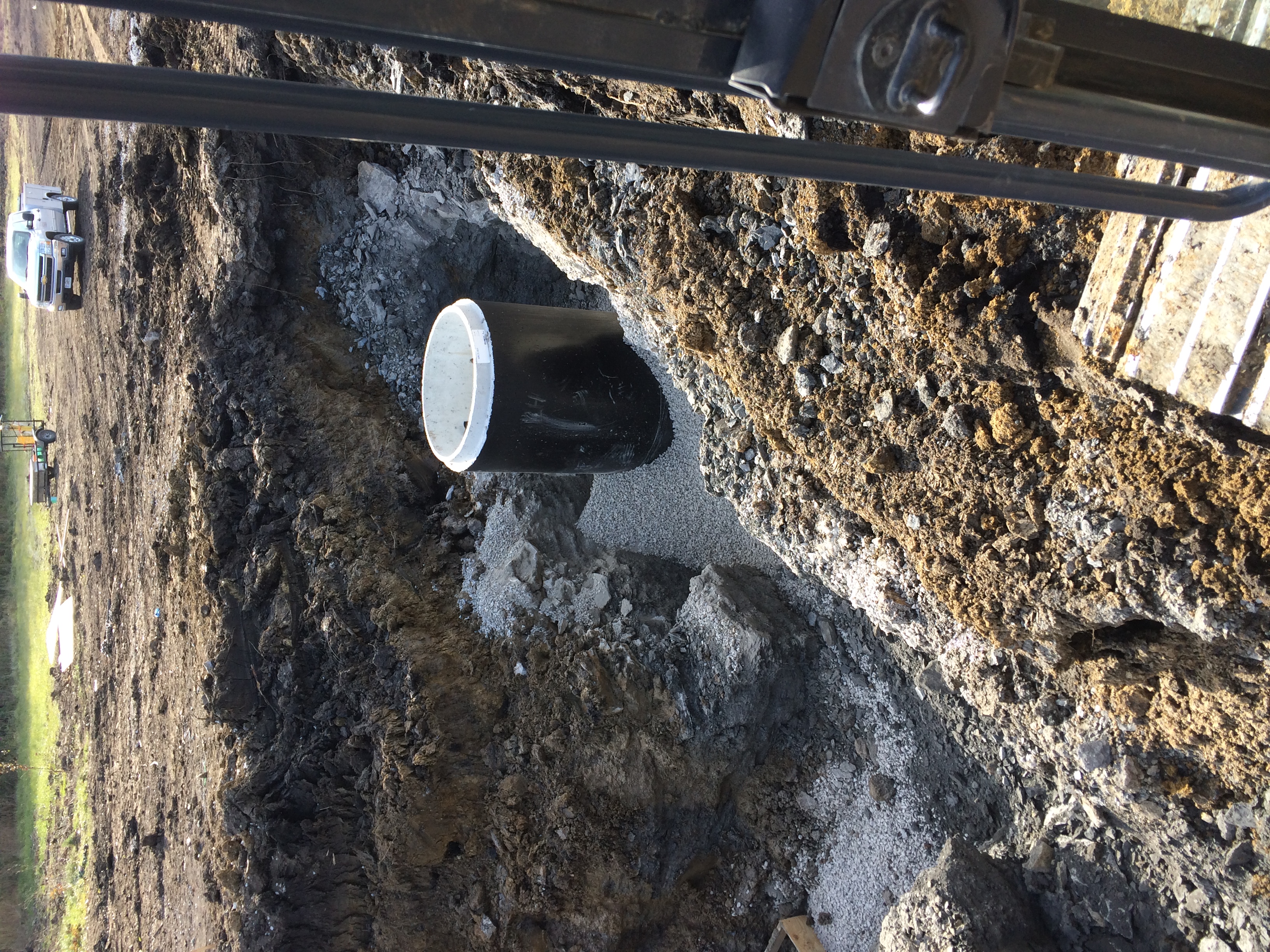

JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
08/28/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
08/28/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
08/28/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
08/28/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
08/28/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
08/28/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
08/28/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
08/28/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
08/28/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/06/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Sanitary Sewer Construction Inspection Partial 09/09/2019
Misc
Informational
09/06/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/06/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/06/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/06/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/06/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
09/06/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/06/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/06/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/06/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/06/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/06/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/09/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Sanitary Sewer Construction Inspection Partial 09/10/2019
Misc
Informational
09/09/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/09/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/09/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/09/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/09/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Corrective Action Required
09/09/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/09/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/09/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/09/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/09/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/09/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/09/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/10/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Sanitary Sewer Construction Inspection Partial 09/12/2019
Misc
Informational
09/10/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/10/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/10/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/10/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/10/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/12/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/10/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/10/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/10/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/10/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/10/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/10/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/10/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/12/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Sanitary Sewer Construction Inspection Partial 09/16/2019
Misc
Informational
09/12/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/12/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/12/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/12/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/12/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/12/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/12/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/12/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/12/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/12/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/12/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/12/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/12/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/12/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/16/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Sanitary Sewer Construction Inspection Partial 09/18/2019
Misc
Informational
09/16/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/16/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/16/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/16/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/16/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/16/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/16/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/16/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/16/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/16/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/16/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/16/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/16/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/16/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/16/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/18/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Site Visit Partial 09/19/2019
Misc
Informational
08/04/2019
MAY 28, 2019 @10:32AM Inspector did not speak to anyone with Earthworks Excavation. Inspector could see that at least 1 person from Earthworks was present and doing some clearing and grubbing.
Misc
Informational
08/04/2019
MAY 30, 2019 @ 3:15PM Earthworks Excavation crews were on site clearing and grubbing.
Misc
Informational
08/04/2019
JUNE 3, 2019 @10:30AM No crews on site.
Misc
Informational
08/04/2019
JUNE 5, 2019 @11:00AM Earthworks Excavation crew is on site clearing and grubbing.
Misc
Informational
08/04/2019
JUNE 6, 2019 @10:10AM No crews were on site.
Misc
Informational
08/04/2019
JUNE 11, 2019 @2:30 PM No crews were on site. Earthworks Excavating has been clearing and grubbing but not here today.
Misc
Informational
08/04/2019
JUNE 18, 2019 @11:00am Earthworks crews were on site grading and mowing.
Misc
Informational
08/04/2019
JUNE 24, 2019 11:45am Inspector spoke with Tim Trigg of Earthworks Excavation. Tim informed inspector that Earthworks crew would start digging this week.
Misc
Informational
08/04/2019
JUNE 25, 2019 @ 9:30AM No crews working on site. Heavy Machinary has been brought on site.
Misc
Informational
08/04/2019
JULY 1, 2019 @10:30AM Earthworks crew was on site. Starting stubb is located in wrong place. Inspector told crew to take pics and submit actual stubb location to their engineers.
Misc
Informational
08/04/2019
JULY 9, 2019 Inspector made site visit to see where crew was with Man hole that is in wrong location. Crews informed Inspector that they were going to core I existing Man hole and start. Inspector informed crew not to do that until their engineers and the City’s engineers worked through their process to correct the problem
Misc
Informational
08/04/2019
JULY 10, 2019 Earthworks Crews have started excavating their first line. Crew and Inspector still waiting on Man hole decision.
Misc
Informational
08/04/2019
JULY 11, 2019 Inspector spoke with Jeff Tyler of Earthworks. Jeff was hoping to core tomorrow July 12, 2019. Inspector spoke with Development Engineer Kent Monter and he said we were still waiting on Engineer Kevin Sterrett to submit revised CAD plans before starting.
Misc
Informational
09/19/2019
SEPTEMBER 19, 2019 Inspector Marquelle Williams assisted with waterline service abandonment across the street from Cobey Creek. Floyd A Long of Raytown, Mo. (913) 208-1367 and Inspector Matt Munger temporarily shut down valves 22953 and 22955 in order to abandon service at vacant house on Cobey Creek Job site.
Site Visit Partial 09/19/2019
Misc
Informational
09/19/2019
MAY 28, 2019 @10:32AM Inspector did not speak to anyone with Earthworks Excavation. Inspector could see that at least 1 person from Earthworks was present and doing some clearing and grubbing.
Misc
Informational
09/19/2019
MAY 30, 2019 @ 3:15PM Earthworks Excavation crews were on site clearing and grubbing.
Misc
Informational
09/19/2019
JUNE 3, 2019 @10:30AM No crews on site.
Misc
Informational
09/19/2019
JUNE 5, 2019 @11:00AM Earthworks Excavation crew is on site clearing and grubbing.
Misc
Informational
09/19/2019
JUNE 6, 2019 @10:10AM No crews were on site.
Misc
Informational
09/19/2019
JUNE 11, 2019 @2:30 PM No crews were on site. Earthworks Excavating has been clearing and grubbing but not here today.
Misc
Informational
09/19/2019
JUNE 18, 2019 @11:00am Earthworks crews were on site grading and mowing.
Misc
Informational
09/19/2019
JUNE 24, 2019 11:45am Inspector spoke with Tim Trigg of Earthworks Excavation. Tim informed inspector that Earthworks crew would start digging this week.
Misc
Informational
09/19/2019
JUNE 25, 2019 @ 9:30AM No crews working on site. Heavy Machinary has been brought on site.
Misc
Informational
09/19/2019
JULY 1, 2019 @10:30AM Earthworks crew was on site. Starting stubb is located in wrong place. Inspector told crew to take pics and submit actual stubb location to their engineers.
Misc
Informational
09/19/2019
JULY 9, 2019 Inspector made site visit to see where crew was with Man hole that is in wrong location. Crews informed Inspector that they were going to core I existing Man hole and start. Inspector informed crew not to do that until their engineers and the City’s engineers worked through their process to correct the problem
Misc
Informational
09/19/2019
JULY 10, 2019 Earthworks Crews have started excavating their first line. Crew and Inspector still waiting on Man hole decision.
Misc
Informational
09/19/2019
JULY 11, 2019 Inspector spoke with Jeff Tyler of Earthworks. Jeff was hoping to core tomorrow July 12, 2019. Inspector spoke with Development Engineer Kent Monter and he said we were still waiting on Engineer Kevin Sterrett to submit revised CAD plans before starting.
Misc
Informational
09/19/2019
SEPTEMBER 19, 2019 Inspector Marquelle Williams assisted with waterline service abandonment across the street from Cobey Creek. Floyd A Long of Raytown, Mo. (913) 208-1367 and Inspector Matt Munger temporarily shut down valves 22953 and 22955 in order to abandon service at vacant house on Cobey Creek Job site.
Misc
Informational
09/19/2019
SEPTEMBER 19, 2019 Earthworks Excavation crews aren’t installing any pipe today. The crews are cleaning up rock and debris from back side of golf course.
Sanitary Sewer Construction Inspection Partial 09/20/2019
Misc
Informational
09/18/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/18/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/18/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/18/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/18/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/18/2019

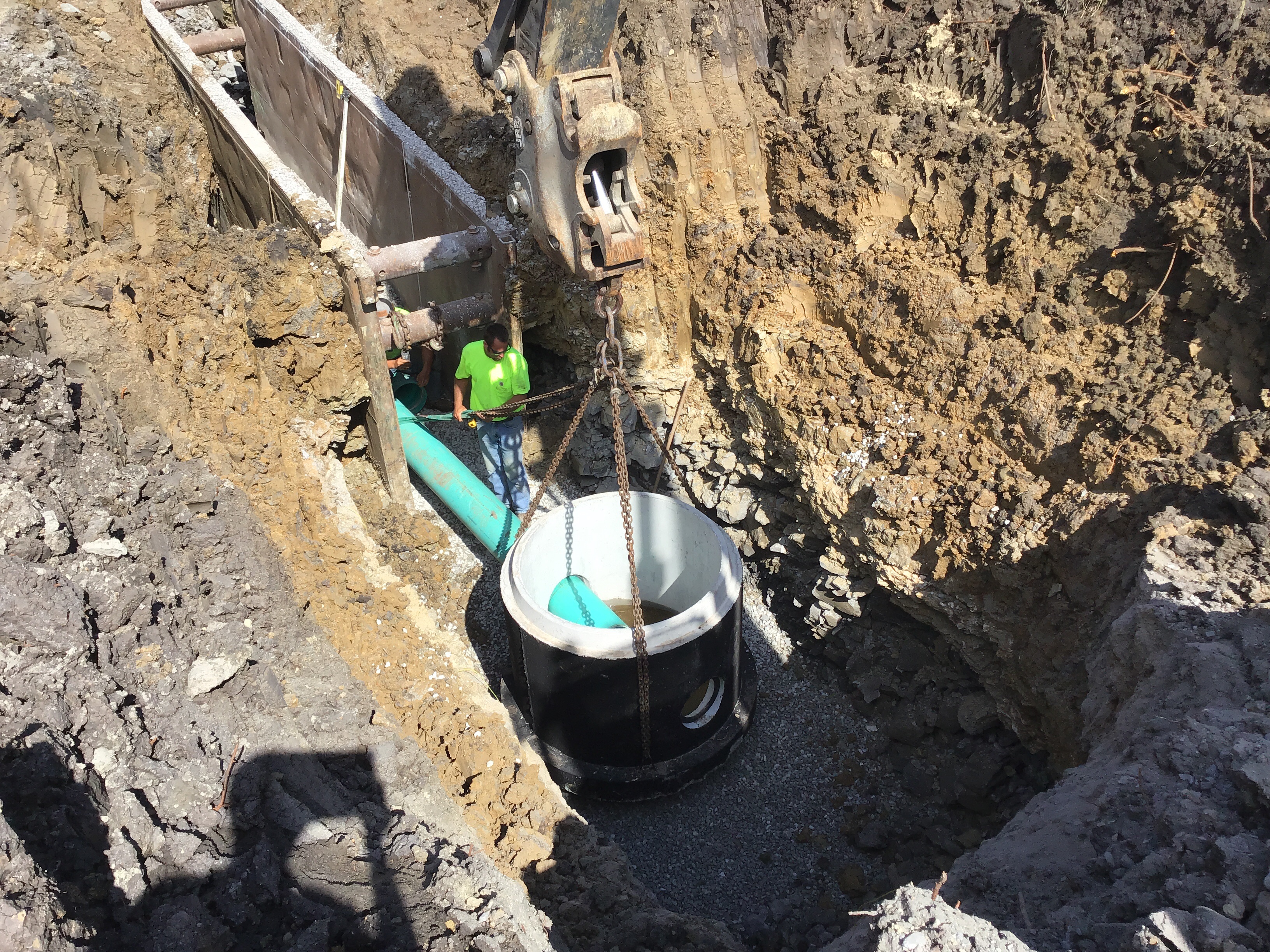

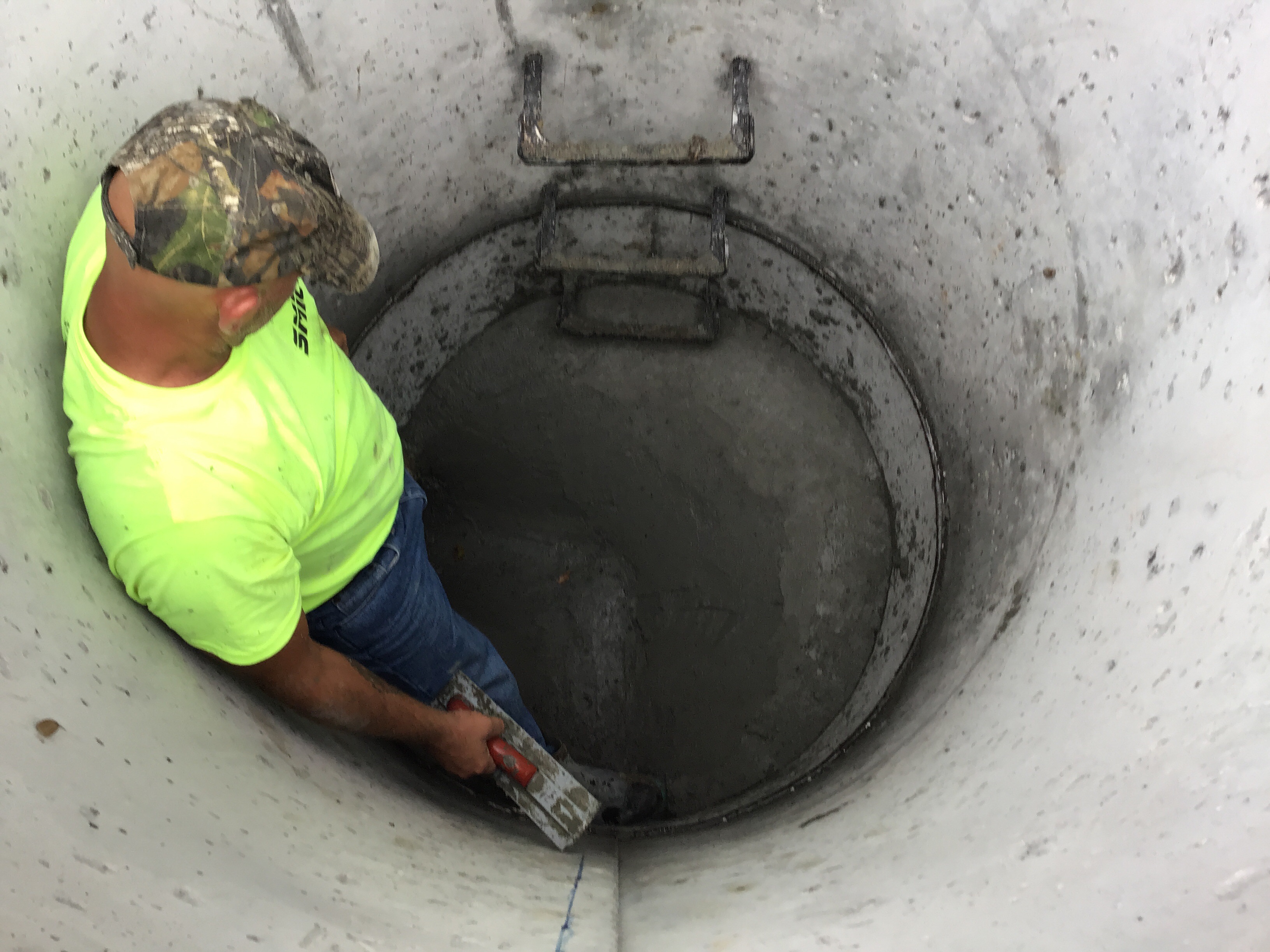

AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/18/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/18/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/18/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/18/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/18/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/18/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/18/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/18/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/18/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/18/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/20/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Sanitary Sewer Construction Inspection Partial 09/24/2019
Misc
Informational
09/20/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/20/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/20/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/20/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/20/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/20/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/20/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/20/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/20/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/20/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/20/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/20/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/20/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/20/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/20/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/20/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/20/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
09/24/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Sanitary Sewer Construction Inspection Partial 09/26/2019
Misc
Informational
09/24/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/24/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/24/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/24/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/24/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/24/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/24/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/24/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/24/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/24/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/24/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/24/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/24/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/24/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/24/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/24/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/24/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
09/24/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
09/26/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Sanitary Sewer Construction Inspection Partial 09/27/2019
Misc
Informational
09/26/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/26/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/26/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/26/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/26/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/26/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/26/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/26/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/26/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/26/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/26/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/26/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/26/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/26/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/26/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/26/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/26/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
09/26/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
09/26/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
09/27/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Sanitary Sewer Construction Inspection Partial 09/30/2019
Misc
Informational
09/27/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/27/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/27/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/27/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/27/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/27/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/27/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/27/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/27/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/27/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/27/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/27/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/27/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/27/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/27/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/27/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/27/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
09/27/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
09/27/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
09/27/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
09/30/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Sanitary Sewer Construction Inspection Partial 10/09/2019
Misc
Informational
09/30/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
09/30/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
09/30/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
09/30/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
09/30/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
09/30/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
09/30/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
09/30/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
09/30/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
09/30/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
09/30/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
09/30/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
09/30/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
09/30/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
09/30/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
09/30/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
09/30/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
09/30/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
09/30/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
09/30/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
09/30/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
10/09/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Grading/Excavation/Fill Inspection Partial 10/09/2019
Misc
Informational
09/06/2019
AUGUST 20, 2019 Earthworks Excavating has started excavating and grading detention pond on east side of site.
Misc
Informational
09/06/2019
SEPTEMBER 6, 2019 BLASTING Explosive Contractors Inc has been onsite September 3,4,6 2019 blasting the rock underground that Earthworks Excavating kept hitting while installing Sanitary Line A
Misc
Informational
10/09/2019
OCTOBER 8, 2019 Macy Construction continues to work on Detention pond. Crews are also moving dirt and excavating trees. Streets have been staked. All work being done is on the onsite portion of project.
Sanitary Sewer Construction Inspection Partial 10/14/2019
Misc
Informational
10/09/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
10/09/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
10/09/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
10/09/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
10/09/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
10/09/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
10/09/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
10/09/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
10/09/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
10/09/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
10/09/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
10/09/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
10/09/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
10/09/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
10/09/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
10/09/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
10/09/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
10/09/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
10/09/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
10/09/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
10/09/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
10/09/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
10/14/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Sanitary Sewer Construction Inspection Partial 10/17/2019
Misc
Informational
10/14/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
10/14/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
10/14/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
10/14/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
10/14/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
10/14/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
10/14/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
10/14/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
10/14/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
10/14/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
10/14/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
10/14/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
10/14/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
10/14/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
10/14/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
10/14/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
10/14/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
10/14/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
10/14/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
10/14/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
10/14/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
10/14/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
10/14/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
10/17/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Sanitary Sewer Construction Inspection Partial 11/05/2019
Misc
Informational
11/04/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/04/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/04/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/04/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/04/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/04/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/04/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/04/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/04/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/04/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/04/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/04/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/04/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/04/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/04/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/04/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/04/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/04/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/04/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/04/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/04/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/04/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/04/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/04/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/04/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/05/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Site Visit Partial 11/06/2019
Misc
Informational
09/19/2019
MAY 28, 2019 @10:32AM Inspector did not speak to anyone with Earthworks Excavation. Inspector could see that at least 1 person from Earthworks was present and doing some clearing and grubbing.
Misc
Informational
09/19/2019
MAY 30, 2019 @ 3:15PM Earthworks Excavation crews were on site clearing and grubbing.
Misc
Informational
09/19/2019
JUNE 3, 2019 @10:30AM No crews on site.
Misc
Informational
09/19/2019
JUNE 5, 2019 @11:00AM Earthworks Excavation crew is on site clearing and grubbing.
Misc
Informational
09/19/2019
JUNE 6, 2019 @10:10AM No crews were on site.
Misc
Informational
09/19/2019
JUNE 11, 2019 @2:30 PM No crews were on site. Earthworks Excavating has been clearing and grubbing but not here today.
Misc
Informational
09/19/2019
JUNE 18, 2019 @11:00am Earthworks crews were on site grading and mowing.
Misc
Informational
09/19/2019
JUNE 24, 2019 11:45am Inspector spoke with Tim Trigg of Earthworks Excavation. Tim informed inspector that Earthworks crew would start digging this week.
Misc
Informational
09/19/2019
JUNE 25, 2019 @ 9:30AM No crews working on site. Heavy Machinary has been brought on site.
Misc
Informational
09/19/2019
JULY 1, 2019 @10:30AM Earthworks crew was on site. Starting stubb is located in wrong place. Inspector told crew to take pics and submit actual stubb location to their engineers.
Misc
Informational
09/19/2019
JULY 9, 2019 Inspector made site visit to see where crew was with Man hole that is in wrong location. Crews informed Inspector that they were going to core I existing Man hole and start. Inspector informed crew not to do that until their engineers and the City’s engineers worked through their process to correct the problem
Misc
Informational
09/19/2019
JULY 10, 2019 Earthworks Crews have started excavating their first line. Crew and Inspector still waiting on Man hole decision.
Misc
Informational
09/19/2019
JULY 11, 2019 Inspector spoke with Jeff Tyler of Earthworks. Jeff was hoping to core tomorrow July 12, 2019. Inspector spoke with Development Engineer Kent Monter and he said we were still waiting on Engineer Kevin Sterrett to submit revised CAD plans before starting.
Misc
Informational
09/19/2019
SEPTEMBER 19, 2019 Inspector Marquelle Williams assisted with waterline service abandonment across the street from Cobey Creek. Floyd A Long of Raytown, Mo. (913) 208-1367 and Inspector Matt Munger temporarily shut down valves 22953 and 22955 in order to abandon service at vacant house on Cobey Creek Job site.
Misc
Informational
09/19/2019
SEPTEMBER 19, 2019 Earthworks Excavation crews aren’t installing any pipe today. The crews are cleaning up rock and debris from back side of golf course.
Misc
Informational
11/06/2019
NOVEMBER 6, 2019 Earthworks Excavation, Inspector and the sites geo tech company picked station numbers and location for lab to pickup proctors for future density testing at street crossings
Sanitary Sewer - Wye / Insert-A-Tee Installation Partial 11/07/2019
Misc
Informational
11/07/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Sanitary Sewer Construction Inspection Partial 11/08/2019
Misc
Informational
11/05/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/05/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/05/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/05/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/05/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/05/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/05/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/05/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/05/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/05/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/05/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/05/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/05/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/05/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/05/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/05/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/05/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/05/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/05/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/05/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/05/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/05/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/05/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/05/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/05/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/05/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/08/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Sanitary Sewer Construction Inspection Partial 11/14/2019
Misc
Informational
11/08/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/08/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/08/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/08/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/08/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/08/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/08/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/08/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/08/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/08/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/08/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/08/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/08/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/08/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/08/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/08/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/08/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/08/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/08/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/08/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/08/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/08/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/08/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/08/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/08/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/08/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/08/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Misc
Informational
11/14/2019
NOVEMBER 14, 2019 Earthworks Excavation crews are excavating and installing Sanitary Sewer line on the ONSITE portion of project. Crew has hit more rock while excavating. Crew has set MH-B6 and are installing pipe toward B-7. MH-B7 is not onsite at this time.
Sanitary Sewer Construction Inspection Partial 11/15/2019
Misc
Informational
11/14/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/14/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/14/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/14/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/14/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/14/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/14/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/14/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/14/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/14/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/14/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/14/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/14/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/14/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/14/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/14/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/14/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/14/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/14/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/14/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/14/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/14/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/14/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/14/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/14/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/14/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/14/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Misc
Informational
11/14/2019
NOVEMBER 14, 2019 Earthworks Excavation crews are excavating and installing Sanitary Sewer line on the ONSITE portion of project. Crew has hit more rock while excavating. Crew has set MH-B6 and are installing pipe toward B-7. MH-B7 is not onsite at this time.
Misc
Informational
11/15/2019
NOVEMBER 15, 2019 Earthworks Excavation is Installing Sanitary Sewer Line on the Onsite portion of the project. The crews have set MH B-6 and are installing pipe toward MH C-1. 3rd party testing lab will be onsite to run compaction test on Monday November 18, 2019 at 1pm. Crews will backfill when Testing lab is on site
Site Visit Partial 11/18/2019
Misc
Informational
11/06/2019
MAY 28, 2019 @10:32AM Inspector did not speak to anyone with Earthworks Excavation. Inspector could see that at least 1 person from Earthworks was present and doing some clearing and grubbing.
Misc
Informational
11/06/2019
MAY 30, 2019 @ 3:15PM Earthworks Excavation crews were on site clearing and grubbing.
Misc
Informational
11/06/2019
JUNE 3, 2019 @10:30AM No crews on site.
Misc
Informational
11/06/2019
JUNE 5, 2019 @11:00AM Earthworks Excavation crew is on site clearing and grubbing.
Misc
Informational
11/06/2019
JUNE 6, 2019 @10:10AM No crews were on site.
Misc
Informational
11/06/2019
JUNE 11, 2019 @2:30 PM No crews were on site. Earthworks Excavating has been clearing and grubbing but not here today.
Misc
Informational
11/06/2019
JUNE 18, 2019 @11:00am Earthworks crews were on site grading and mowing.
Misc
Informational
11/06/2019
JUNE 24, 2019 11:45am Inspector spoke with Tim Trigg of Earthworks Excavation. Tim informed inspector that Earthworks crew would start digging this week.
Misc
Informational
11/06/2019
JUNE 25, 2019 @ 9:30AM No crews working on site. Heavy Machinary has been brought on site.
Misc
Informational
11/06/2019
JULY 1, 2019 @10:30AM Earthworks crew was on site. Starting stubb is located in wrong place. Inspector told crew to take pics and submit actual stubb location to their engineers.
Misc
Informational
11/06/2019
JULY 9, 2019 Inspector made site visit to see where crew was with Man hole that is in wrong location. Crews informed Inspector that they were going to core I existing Man hole and start. Inspector informed crew not to do that until their engineers and the City’s engineers worked through their process to correct the problem
Misc
Informational
11/06/2019
JULY 10, 2019 Earthworks Crews have started excavating their first line. Crew and Inspector still waiting on Man hole decision.
Misc
Informational
11/06/2019
JULY 11, 2019 Inspector spoke with Jeff Tyler of Earthworks. Jeff was hoping to core tomorrow July 12, 2019. Inspector spoke with Development Engineer Kent Monter and he said we were still waiting on Engineer Kevin Sterrett to submit revised CAD plans before starting.
Misc
Informational
11/06/2019
SEPTEMBER 19, 2019 Inspector Marquelle Williams assisted with waterline service abandonment across the street from Cobey Creek. Floyd A Long of Raytown, Mo. (913) 208-1367 and Inspector Matt Munger temporarily shut down valves 22953 and 22955 in order to abandon service at vacant house on Cobey Creek Job site.
Misc
Informational
11/06/2019
SEPTEMBER 19, 2019 Earthworks Excavation crews aren’t installing any pipe today. The crews are cleaning up rock and debris from back side of golf course.
Misc
Informational
11/06/2019
NOVEMBER 6, 2019 Earthworks Excavation, Inspector and the sites geo tech company picked station numbers and location for lab to pickup proctors for future density testing at street crossings
Misc
Informational
11/18/2019

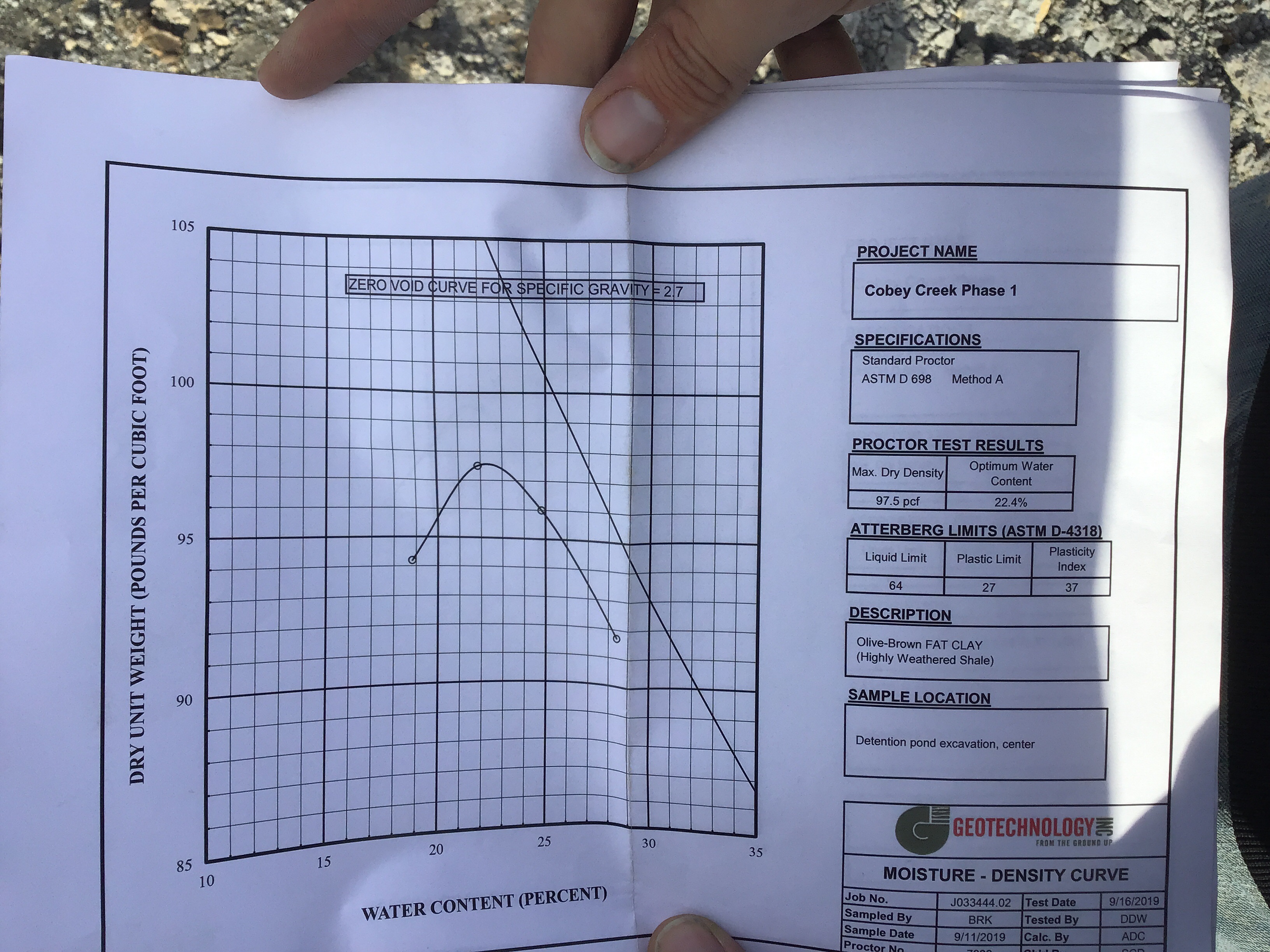

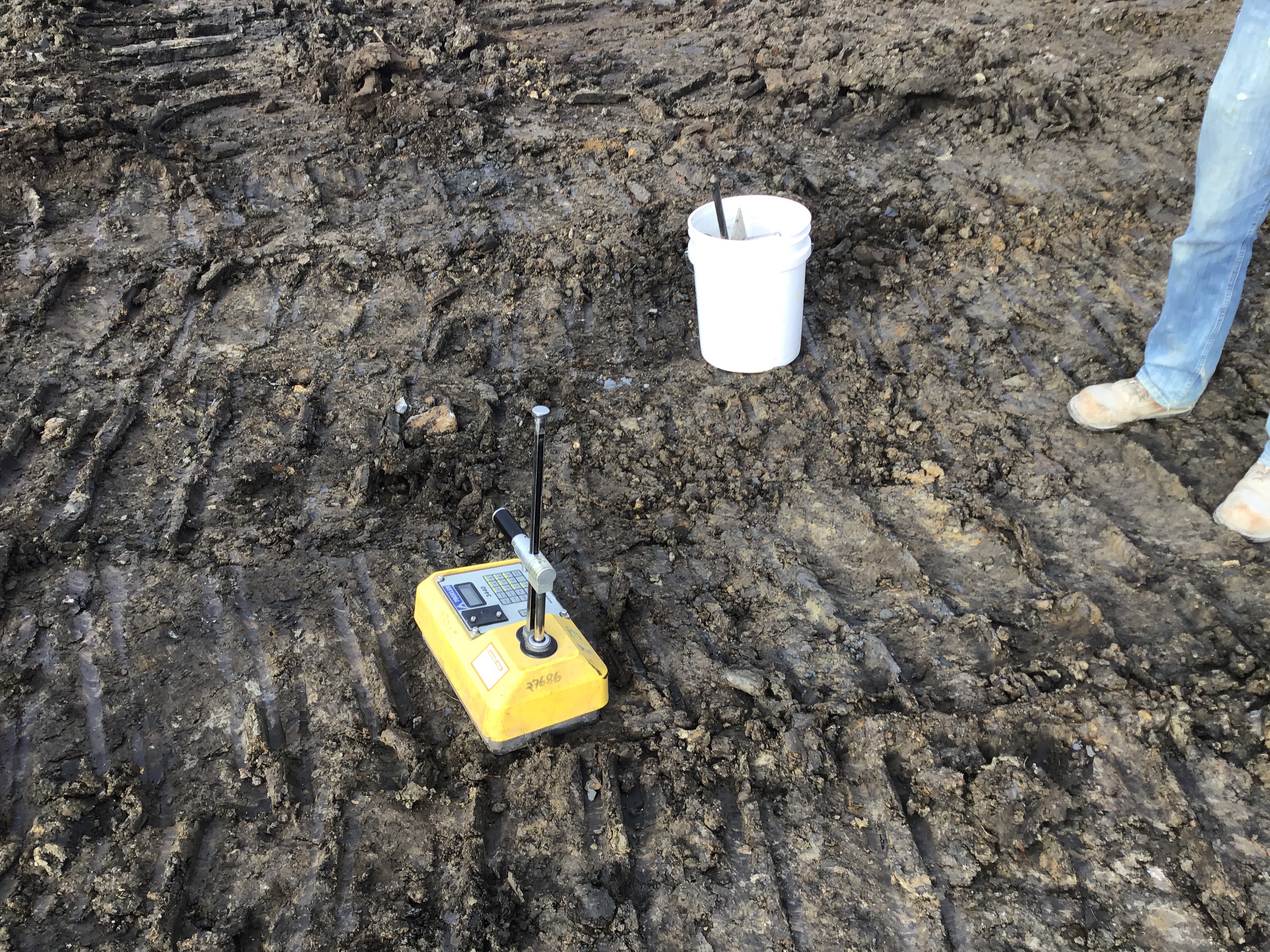

NOVEMBER 18, 2019 Geotechnology laboratories are onsite to perform density on the C service lines. The lab technician is performing densities at every street crossing laterals in 3 layers, each layer consisting of approx. 1-1 1/2 inch layers. Lab had previously picked up 4 to 5 proctors in order to perform density testing.
Sanitary Sewer Construction Inspection Partial 11/19/2019
Misc
Informational
11/15/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/15/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/15/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/15/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/15/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/15/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/15/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/15/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/15/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/15/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/15/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/15/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/15/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/15/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/15/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/15/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/15/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/15/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/15/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/15/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/15/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/15/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/15/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/15/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/15/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/15/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/15/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Misc
Informational
11/15/2019
NOVEMBER 14, 2019 Earthworks Excavation crews are excavating and installing Sanitary Sewer line on the ONSITE portion of project. Crew has hit more rock while excavating. Crew has set MH-B6 and are installing pipe toward B-7. MH-B7 is not onsite at this time.
Misc
Informational
11/15/2019
NOVEMBER 15, 2019 Earthworks Excavation is Installing Sanitary Sewer Line on the Onsite portion of the project. The crews have set MH B-6 and are installing pipe toward MH C-1. 3rd party testing lab will be onsite to run compaction test on Monday November 18, 2019 at 1pm. Crews will backfill when Testing lab is on site
Misc
Informational
11/19/2019
NOVEMBER 19, 2019 Earthworks Excavation crews are excavating, and installing Sanitary Line C for services.
Sanitary Sewer Construction Inspection Partial 11/20/2019
Misc
Informational
11/19/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/19/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/19/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/19/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/19/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/19/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/19/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/19/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/19/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/19/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/19/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/19/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/19/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/19/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/19/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/19/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/19/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/19/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/19/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/19/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/19/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/19/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/19/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/19/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/19/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/19/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/19/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Misc
Informational
11/19/2019
NOVEMBER 14, 2019 Earthworks Excavation crews are excavating and installing Sanitary Sewer line on the ONSITE portion of project. Crew has hit more rock while excavating. Crew has set MH-B6 and are installing pipe toward B-7. MH-B7 is not onsite at this time.
Misc
Informational
11/19/2019
NOVEMBER 15, 2019 Earthworks Excavation is Installing Sanitary Sewer Line on the Onsite portion of the project. The crews have set MH B-6 and are installing pipe toward MH C-1. 3rd party testing lab will be onsite to run compaction test on Monday November 18, 2019 at 1pm. Crews will backfill when Testing lab is on site
Misc
Informational
11/19/2019
NOVEMBER 19, 2019 Earthworks Excavation crews are excavating, and installing Sanitary Line C for services.
Misc
Informational
11/20/2019
NOVEMBER 20, 2019 Earthworks Excavation crew is continuing to excavate, install and back fill sanitary Line C from MH-B6 on the onsite portion of the project
Misc
Informational
04/07/2020
On Monday, 4-06-2020. The Earthworks Contractor installed 6”service lines on Sanitary line B. Stations include 16+94, 17+ 38, 17+ 59 and 18+07. Flowable fill was placed also.
Misc
Informational
04/23/2020
On Thursday, 4-23-2020, Earth Works Excavation completed the Sanitary Sewer line B and installed MH B-10 with all House connections. House taps were flowable filled on yesterday and back filling and compaction testing will be completed today.
Sanitary Sewer - Wye / Insert-A-Tee Installation Partial 12/03/2019
Misc
Informational
11/07/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Misc
Informational
12/03/2019
DECEMBER 3, 2019 Earthworks Excavation crews have set MH C-1 on the Onsite portion of the project and are installing services along the way. Crews are bringing green wire above grade to indicate where service lines are located.
Sanitary Sewer - Vacuum Passed 06/02/2020
Misc
Informational
06/02/2020
Vacuum test were performed on MH ‘s A8,A7, A6 and B4 and passed
Misc
Informational
06/03/2020
On Wednesday, 6-03-2020. I performed Vacuum test on MH’s A2, A3, A4, A5 and A6. All passed testing. Had to re-seal MH’s A6 and A3 due to riser leakage.
Sanitary Sewer - Mandrel Passed 06/03/2020
Misc
Informational
06/02/2020
Mandrels were preformed on 5-12-2020, 5-13-2020, 5-21-2020 and 6-2-2020 between the following MH’s. B1 thru. B10, D1 to D4 and MH C1 - C3 and A8 thru A6.
Misc
Informational
06/03/2020
On Wednesday, 6-03-2020. I preformed Mandrel testing between MH’s A6 to A5, A5 to A4 for 12” pipe. Test passed.
Misc
Informational
10/08/2020
Mandrels were performed where all “Y”s were disturbed when resetting laterals throughout project. Water services was notified the contractor was ready to have system camera ed again. Mandreled passed.
Sanitary Sewer - Air Test Passed 06/03/2020
Misc
Informational
06/02/2020
On 5-13-2020. Earth Works excavating completed mandrel’s for MH B7 thru H1, D1 and D2 . B6 to C1 and C2.
Misc
Informational
06/02/2020
On 5-21-2020. Earth Works contractor resumed testing for sanitary sewers. Mandrels Vacuum and air testing was preformed at MH B3, B4, B2, B1 and A9. All testing pipe, MH’s and vacuum test passed.
Misc
Informational
06/02/2020
On Tuesday, 6-2-2020 Earth Works resumed Air testing Pipe from MH’s A9 thru A6. All pipe passed testing.
Misc
Informational
06/03/2020
On Wednesday, 6-03-2020. I preformed air testing on the following pipe sections. 12” from MH A6 to A5, A5 to A4. 15” from A4 to A3, and MH A3 to A2 and 18” DIP A2 to A1. All passing.
Misc
Informational
10/08/2020
On Tuesday, 10-06-2020. Air testing for the Sanitary Sewer system where all laterals were removed and replaced were air tested and passed inspections.
Pavement-Proof Roll Passed 07/08/2020
Misc
Informational
07/08/2020
On Wednesday, 7-08-2020. A proof roll on the sub-base was performed and passed on all of the sub-division at Cobey Creek Sub-division.
Water Line - Hydrostatic Test Passed 07/08/2020
Misc
Informational
07/08/2020
On Thursday, 7-02-2020 and Monday, 7-06-2020. Contractor Earth Works completed all Hydrostatic pressure testing on 12” and 8” waterlines. Pressure test passed all testing on waterlines.
Erosion Control Inspection Passed 07/23/2020
Misc
Informational
07/23/2020
On Wednesday and Thursday 7-22-2020 and 7-23-2020. Contractor worked installing the 6’x6’ Detention basin structure in the front of the project. Contractor also poured the invert and the collars around the pipes.
Water Line - Coliform Test 1 Partial 08/12/2020
Misc
Informational
07/13/2020
On Monday, 7-13-2020. A Cloriform test was completed on all waterlines on project. Test samples were delivered to lab for testing.
Misc
Informational
07/15/2020
On Tuesday, 7-14-2020. The results of the chloroform all passed except sta. 2+17 on line #F. Contractor was notified and a second set of test were preformed. Results will be known on tomorrow.
Misc
Informational
07/17/2020
On yesterday 7-16-2020. The Cloriform test for sta. 2+17 did not pass on today. We will retest for a positive result shortly until it passes.
Misc
Informational
07/23/2020
On Thursday, 7-23-2020. Earth Works provided Cloriform test water samples for Line G and samples were taken to lab for results.
Misc
Informational
07/25/2020
Water sample taken on 7-22-2020 failed at sta. 13+05. Will wait for sample results from sample taken 7-23-2020.
Misc
Informational
07/30/2020
Water Samples taking on 7-23-2020 both failed Cloriform test and will need to be retaking.
Misc
Informational
08/06/2020
Water samples were taken again on 8-03-2020 to Blue Valley Lab for testing and it was determined the samples failed and had Coliform present. Samples will be taken again.
Misc
Informational
08/06/2020
Water samples were taken again for line G and taken to Blue Valley Lab. Both samples passed with nothing retaining in the samples.
Misc
Informational
08/12/2020
On 8-04-2020. A water sample was taken to Blue Valley Lab for testing and it as determined to test positive for bacteria. Testing will be done again because not getting (2) consecutive passing test.
Misc
Informational
08/12/2020
On 8-10-2020. Water samples were taken again from sta. 13+05 and 2+17. Station 2+17 passed but 13+05 failed for bacteria presents. Contractor was notified to re-chlorinate 8” water line.
Misc
Informational
09/15/2020
Water samples were taken on 9-03-2020 and 9-04-2020 for line G sta. 2+17 and 13+05. Test results showed sample 2+17 passed both test but sample 13+05 failed the second test. Samples will be completed again for the location.
Misc
Informational
09/15/2020
On Tuesday, 9-08-2020. I took a water samples for sta. 13+05 on line G.
Misc
Informational
09/15/2020
On Thursday, 9-10-2020. Test results again failed the water sample taken on 9-08-2020. Contractor was notified.
Misc
Informational
09/15/2020
On Monday, 9-14-2020. A water sample was taken at sta. 13+05 on line G.
Misc
Informational
09/17/2020
On Tuesday, 9-15-2020. Results of the water sample failed from day prior. Another sample was take at the failed location.
Misc
Informational
09/17/2020
On Wednesday, 9-16-2020 the results from the water sample taken on 9-15-2020 failed Chloroform bacteria testing again. Contractor is taking more samples and also will take a sample test from the city’s main to see if the main does not meet bacteria test.
Misc
Informational
10/08/2020
On Wednesday, 10-07-2020. Earth Works took another water sample from sta. 13+05. Sample was taken to lab at 11:30 am.
Misc
Informational
10/08/2020
On 10-08-2020. Another water sample was taken to testing lab for bacteria testing . sample results from yesterday’s sample have not return as of yet.
Sanitary Sewer - Mandrel Passed 10/15/2020
Misc
Informational
06/02/2020
Mandrels were preformed on 5-12-2020, 5-13-2020, 5-21-2020 and 6-2-2020 between the following MH’s. B1 thru. B10, D1 to D4 and MH C1 - C3 and A8 thru A6.
Misc
Informational
10/15/2020
As of Thursday,10-14-2020 all mandrels have been performed and passed testing. Even locations Done twice after waters 1st punchlist.
Sanitary Sewer - Air Test Passed 10/15/2020
Misc
Informational
06/02/2020
On 5-13-2020. Earth Works excavating completed mandrel’s for MH B7 thru H1, D1 and D2 . B6 to C1 and C2.
Misc
Informational
10/15/2020
As of Thursday, 10-13-2020. All air testing for project for Sanitary Sewers have been completed and passed testing.
Curb - Proof Roll Passed 11/10/2020
Misc
Informational
11/10/2020
On 10-21-2020, Earth Works completed fine grading for curb installation and proof rolled sub-base.
Public Curb Inspection Passed 11/30/2020
Misc
Informational
11/11/2020
Geo-Tech consultants provided concrete testing. Air was 6.5%, slump was 1” and temp of concrete is 70 degrees. 4 Cyl. Were taken.
Misc
Informational
11/12/2020
On Wednesday, 11-11-2020. Earth Works completed mass grading for curb back filling and project site finish grading.
Misc
Informational
11/12/2020
On Wednesday, 11-11-2020. JK Conctrete installed approx 2,500 LF of CG-1 curbing. All curbing cured and (3) throats were poured as well
Misc
Informational
11/12/2020
On Thursday, 11-12-2020. JK Concrete formed and poured 8 throats for Cobey Creek Subdivison
Misc
Informational
11/16/2020
On Friday 11-13-2020. JK Concrete completed all concrete throats for Cobey Creek. Contractor tied-in all remaining curbing. Contractor has approx. 120 LF to complete at the entrance of Cobey Creek Dr and 150 Hwy.
Misc
Informational
11/30/2020
On Friday, 11-27-2020. JK Concrete finished the remaining curb on project.
Pavement-Surface Passed 12/01/2020
Misc
Informational
11/20/2020
On Thursday, 11-19-2020. Hanarhan Asphalt Began installating Type 5 base on following streets. Corbin, Carter, David and Cobey Creek Dr. Contractor stopped at Jud Rd. Compaction testing was provided by Kansas City testing. Max Density was 148.7 and testing ranged from 95% comp. to 98.0%.
Misc
Informational
12/01/2020
On Thursday, 11-19-2020, Asphalt contractor began placement of surface asphalt completing Carter Street and half of Corbin Street.
Misc
Informational
12/01/2020
Thursday’s asphalt placement was tested and passed by Kansas City Testing with Max Density of 148.7 passing with densities or 95% to 99%.
Storm - Outlet Structure Passed 12/04/2020
Misc
Informational
10/01/2020
On Tuesday, 9-29-2020. Earth Works Set forms, tied steel and poured base for north Detention pond Structure.
Misc
Informational
10/01/2020
On Wednesday, 9-30-2020. Earth Works formed and tied steel and pour walls for the Detention Structure located at the north end of the project. Contractor also completed coupling repair at the existing Sanitary Man Hole where the start of the Sanitary Line started.
Misc
Informational
11/20/2020
On Thursday, 11-19-2020. Earth Works began installation of the Double 48” RCP out flow piping for the north Detention Basin. Approximately 24 LF of duel piping was installed.
Misc
Informational
11/20/2020
On Friday, 11-20-2020. Earth Works resumed 48” detention piping for north Detention Basin.
Misc
Informational
12/01/2020
On Monday, Earth Works completed placement of the out flow RCP pipe and end sections for the north detention basin and backfilled.
Misc
Informational
12/01/2020
On Tuesday, 12-1-2020. Earth Works began the installation of the Storm Sewer system for the north detention basin. 250 LF of 24” HDPE pipe and (1) neoplasticism Man Hole was installed on the east bank of the basin.
Misc
Informational
12/01/2020
On Tuesday, 12-01-2020. Earth Works Excavating poured the Dog house and invert for the duel 48” RCP’s located at the north Detention Basin. They also placed approx 170 LF of 24” HDPE pipe on the east side of the detention basin.
Misc
Informational
12/04/2020
On Thursday, 12-03-2020. Earth Works Excavating resumed installation of the Storm Sewer system located in the north detention basin. Contractor placed 275 LF of HDPE 24” pipe with (1) neo-plastic MH. End sections were also installed.
Pavement-Surface Passed 12/08/2020
Misc
Informational
12/01/2020
On Thursday, 11-19-2020. Hanarhan Asphalt Began installating Type 5 base on following streets. Corbin, Carter, David and Cobey Creek Dr. Contractor stopped at Jud Rd. Compaction testing was provided by Kansas City testing. Max Density was 148.7 and testing ranged from 95% comp. to 98.0%.
Misc
Informational
12/01/2020
On Thursday, 11-19-2020, Asphalt contractor began placement of surface asphalt completing Carter Street and half of Corbin Street.
Misc
Informational
12/01/2020
On Tuesday, 12-01-2020. Hanharan asphalt graded the sub grade entrance from 150 Hwy. to the project entrance and compacted for 1st lift of base asphalt for tomorrow.
Misc
Informational
12/08/2020
On Friday 12-04-2020. Hanarhan Asphalt placed remaining base lift of Asphalt at the entrance of Cobey Creek Pkwy and also layed base on the merge roadway of 150Hwy. Geo Tech provided the testing. Compaction test passed spec’s with 95% and higher readings.
Storm Sewer Construction Inspection Passed 01/12/2021
Misc
Informational
03/17/2020
The Earthworks Crew was on site working on Storm Sewer Line 01. The crew installed storm box 01-C and was working on installing the HDPE pipe between 01-C and 01-D. The collar for box 01-C was installed and photos of the work are uploaded into the system. The crew plans to continue the storm line install today but with a rain event in the forecast they will potentially off tomorrow.
Misc
Informational
03/30/2020
I inspected installation of 30 LF. of 60” storm sewer HDPE pipe from FI- 1C. Fill was mostly rock so installation was very slow. Also I inspected approx. 20LF. Of sanitary sewer located form line B7. Again installation is very limited due to rock fill.
Misc
Informational
03/31/2020
I inspected installation of 30 LF. of 60” storm sewer HDPE pipe from FI- 1C. Fill was mostly rock so installation was very slow. Also I inspected approx. 20LF. Of sanitary sewer located form line B7. Again installation is very limited due to rock fill.
Misc
Informational
03/31/2020
As of 3-24-2020 I will take over project form John DiMauro. Project was rained out on 3-26-2020. Contractor return on Friday 3-26-2020. Resumed Storm Sewer installation on line (1) installing approx. 24LF of 60” HDPE between 01-C thru 02-D.
Misc
Informational
03/31/2020
On Monday 3-30-2020, Contractor resumes installation of line (1) between 01-C & 01-D placing 60” HDPE. Installed approx. 2 - sections of pipe (24LF) and backfilled.
Misc
Informational
03/31/2020
Tuesday, 3-31-2020 contractor completes line (1) 01-C thru 01-D and place 01-D Field Inlet (7’x7’) at Sta. 18+41.94 Corbin Dr.
Misc
Informational
04/01/2020
On Wednesday, 4-01-2020. Contractor continued 60” Storm Sewer Installation. Pipe 14 LF. Of 60” pipe was placed west of the Field Inlet O1-D.
Misc
Informational
04/02/2020
On Thursday, 4-02-2020 The contractor resumed 60” Storm Sewer installation for Line #1. Contractor placed 68 LF. Of 60” HDPE pipe out of box 01-D heading west towards box 01-F at station 18+41.94 and started back filling line #1 from 01-C thru 01-D will soil.
Misc
Informational
04/07/2020
On Monday, 4-06-2020 Contractor resumed 60” storm sewer installation on line 1. Inlet 01-E at Sta. 18+41 was set along with box 01-F at sta. 10+51. Contractor also placed Approx. 100LF of 60” HDPE pipe between this (2) Structures.
Misc
Informational
04/07/2020
On Monday, 4-06-2020 Contractor resumed 60” storm sewer installation on line 1. Inlet 01-E at Sta. 18+41 was set along with box 01-F at sta. 10+51. Contractor also placed Approx. 100LF of 60” HDPE pipe between this (2) Structures.
Misc
Informational
04/07/2020
Contractor Earthworks Excavation has installed 68LF of 60” HDPE Storm Sewer and Str.01F at sta.10+51. Also they have installed Str.01-F2, 01-G, Str. 01-H including on line #1. Finally, 286 LF of 42” HPDE pipe has been placed as well. Temp. 80 for the High.
Misc
Informational
04/07/2020
Contractor Earthworks Excavation has installed 68LF of 60” HDPE Storm Sewer and Str.01F at sta.10+51. Also they have installed Str.01-F2, 01-G, Str. 01-H including on line #1. Finally, 286 LF of 42” HPDE pipe has been placed as well. Temp. 80 for the High. Contractor back filled around Field Inlet structure 01-C at sta. 20+63.
Misc
Informational
04/08/2020
Contractor Earthworks Excavation has installed 68LF of 60” HDPE Storm Sewer and Str.01F at sta.10+51. Also they have installed Str.01-F2, 01-G, Str. 01-H including on line #1. Finally, 286 LF of 42” HPDE pipe has been placed as well. Temp. 80 for the High. Contractor back filled around Field Inlet structure 01-C at sta. 20+63.
Misc
Informational
04/08/2020
Contractor Earthworks resumed installation of 42” storm sewer. Installed 240LF of pipe and placed Str. 0-1K. Contractor completed backfill for about 300 LF of storm sewer and Geotechnical come and took density compaction test on the fill areas. All (3) test passed with densities from 97.2% thru 98.0%.
Misc
Informational
04/09/2020
On Thursday, 4-09-2020, Contractor Earthworks installed (2) Str. 01-G and 01-H on line 1. They installed 87LF of 42” HDPE pipe in between the Structures and place some rock back fill over the pipe. They also installed Str. 05-A of line 5 and placed 40.5 LF of 36” HDPE pipe into intersecting Str. 01-G.
Misc
Informational
04/10/2020
On 4-10-2020 Contractor Earthworks resumed sewer Installation. Contractor installed Str.06-A and laid approx. 80 LF of 36” HDPE pipe. Also installed (1) Flared End Section with toe wall on line #5.
Misc
Informational
04/13/2020
On 4-10-2020 Contractor Earthworks resumed sewer Installation. Contractor installed Str.06-A and laid approx. 80 LF of 36” HDPE pipe. Also installed (1) Flared End Section with toe wall on line #5.
Misc
Informational
04/13/2020
On Monday 4-13-2020. Contractor Earth Works resumed Storm Sewer installation of Line #1 installing approx. 64 LF of 30” HDPE pipe as well as installing Structures 01-M & 01-N.
Misc
Informational
04/14/2020
On 4-10-2020 Contractor Earthworks resumed sewer Installation. Contractor installed Str.06-A and laid approx. 80 LF of 36” HDPE pipe. Also installed (1) Flared End Section with toe wall on line #5.
Misc
Informational
04/14/2020
On Monday 4-13-2020. Contractor Earth Works resumed Storm Sewer installation of Line #1 installing approx. 64 LF of 30” HDPE pipe as well as installing Structures 01-M & 01-N.
Misc
Informational
04/14/2020
On Tuesday, 4-14-2020 Contractor Earthworks resumed Storm and Sanitary sewer installation. 638 LF of 15” HDPE pipe was installed with Structures 01-F4,01-F3 and 01-F2 on line F. Contractor also installed 42” HDPE pipe between Str. 01-J and 01-K. 80 LF of 42” HDPE pipe was installed as well.
Misc
Informational
04/15/2020
On Wednesday, 4-15-2020 Earth Works Excavation resumed sanitary installation between MH B8 & B9. Contractor completed 3 service connection and placed flowable fill and back filled some of sewer installed.
Misc
Informational
04/15/2020
On Wednesday,Contractor resumed placement of storm sewers. Structures 01-F4, 01-F2, 01-K and 01-J had concrete dog houses poured and inverts as well. Concrete collars were poured for Str.01-G, 01-A, 01-J and CB- 1I. Approx. 100 LF of 42” HDPE Pipe was installed for line 1-A.
Misc
Informational
04/20/2020
On Wednesday,Contractor resumed placement of storm sewers. Structures 01-F4, 01-F2, 01-K and 01-J had concrete dog houses poured and inverts as well. Concrete collars were poured for Str.01-G, 01-A, 01-J and CB- 1I. Approx. 100 LF of 42” HDPE Pipe was installed for line 1-A.
Misc
Informational
04/20/2020
On 4-20-2020, Earth Works Excavation resumed storm Sewer installation. Contractor installed 56 LF of 24” HDPE pipe and Str. 01-E and Str.02-A. Also installed Str. 02-B and 250 LF of 18” HDPE pipe towards Str. 02-C
Misc
Informational
04/20/2020
Earth Works Crew #2 continued to install Line 1. Set Str. 01-K and approx. 150 LF of 42” HDPE pipe and 100 LF of 36” HDPE pipe heading towards Str. 01-M.
Misc
Informational
04/21/2020
Earth Works Crew #2 continued to install Line 1. Set Str. 01-K and approx. 150 LF of 42” HDPE pipe and 100 LF of 36” HDPE pipe heading towards Str. 01-M.
Misc
Informational
04/21/2020
On Tuesday, 4-21-2020. Earth Works Excavation resumed Storm Sewer installation. Installed 208 LF of 30” HDPE pipe between Str. Str. 01-L to 01-M and set structure 01-M. Crew #2 set on line 2 between Str. 02-B and 02 -C approx. 320 LF of 18” HDPE pipe and set Str. 02-C.
Misc
Informational
04/22/2020
Earth Works Crew #2 continued to install Line 1. Set Str. 01-K and approx. 150 LF of 42” HDPE pipe and 100 LF of 36” HDPE pipe heading towards Str. 01-M.
Misc
Informational
04/22/2020
On Tuesday, 4-21-2020. Earth Works Excavation resumed Storm Sewer installation. Installed 208 LF of 30” HDPE pipe between Str. Str. 01-L to 01-M and set structure 01-M. Crew #2 set on line 2 between Str. 02-B and 02 -C approx. 320 LF of 18” HDPE pipe and set Str. 02-C.
Misc
Informational
04/22/2020
On 4-22-2020, Earth Works resumes Storm Sewer Installation at Line 12. Installing 30” HDPE pipe between Str.12-F and12-G. Also crew #2 resumed installation of line 1 installing Str. 01-N and 01-0 with 64 LF of 30” HDPE pipe.
Misc
Informational
04/28/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
04/29/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
04/29/2020
On 4-29-2020. Contractor Earth Works resumed installation of storm line 19 installing 100 LF of 18” HDPE pipe and the end section 19-B.
Misc
Informational
04/30/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
04/30/2020
On 4-29-2020. Contractor Earth Works resumed installation of storm line 19 installing 100 LF of 18” HDPE pipe and the end section 19-B.
Misc
Informational
04/30/2020
On Thursday, 4-30-2020. Contractor Earth Works completed the following. 1. Installed Storm Sewer at line #2 Str. 02-B, 02-C & 02-D. Placed approx 200 LF of 18” HDPE pipe and is31 LF of 15” HDPE pipe. 2. On line 8 Str. 08-A, 126 LF 24” HDPE pipe to 08-B thru 08-C Flared in section 60 LF 18” HDPE pipe. 3. Grading Detention ponds between line 9 and line 8. 4. Crew #3 - Boring under 150HWY found 16” abandoned water main. Called designer and am awaiting answer to bore through it.
Misc
Informational
05/06/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
05/06/2020
On 4-29-2020. Contractor Earth Works resumed installation of storm line 19 installing 100 LF of 18” HDPE pipe and the end section 19-B.
Misc
Informational
05/06/2020
On Thursday, 4-30-2020. Contractor Earth Works completed the following. 1. Installed Storm Sewer at line #2 Str. 02-B, 02-C & 02-D. Placed approx 200 LF of 18” HDPE pipe and is31 LF of 15” HDPE pipe. 2. On line 8 Str. 08-A, 126 LF 24” HDPE pipe to 08-B thru 08-C Flared in section 60 LF 18” HDPE pipe. 3. Grading Detention ponds between line 9 and line 8. 4. Crew #3 - Boring under 150HWY found 16” abandoned water main. Called designer and am awaiting answer to bore through it.
Misc
Informational
05/06/2020
Contractor Earth Works resumes Storm Sewer installation. Line #5 was installed. Str. 05-C, 05-D and 05-E are installed with approx. 80 LF of 15” HDPE pipe. Crew #2 installed Str. 12-F and 18-A on line 18. 32 LF of 18” HDPE pipe was placed as well.
Misc
Informational
05/07/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
05/07/2020
On 4-29-2020. Contractor Earth Works resumed installation of storm line 19 installing 100 LF of 18” HDPE pipe and the end section 19-B.
Misc
Informational
05/07/2020
On Thursday, 4-30-2020. Contractor Earth Works completed the following. 1. Installed Storm Sewer at line #2 Str. 02-B, 02-C & 02-D. Placed approx 200 LF of 18” HDPE pipe and is31 LF of 15” HDPE pipe. 2. On line 8 Str. 08-A, 126 LF 24” HDPE pipe to 08-B thru 08-C Flared in section 60 LF 18” HDPE pipe. 3. Grading Detention ponds between line 9 and line 8. 4. Crew #3 - Boring under 150HWY found 16” abandoned water main. Called designer and am awaiting answer to bore through it.
Misc
Informational
05/07/2020
Contractor Earth Works resumes Storm Sewer installation. Line #5 was installed. Str. 05-C, 05-D and 05-E are installed with approx. 80 LF of 15” HDPE pipe. Crew #2 installed Str. 12-F and 18-A on line 18. 32 LF of 18” HDPE pipe was placed as well.
Misc
Informational
05/07/2020
Earth Works crew resumed installation of the storm sewer for line 15. Also completed some concrete inverts at various structures.
Misc
Informational
05/11/2020
On Tuesday, 4-28-2020, Contractor Earth Works resumed Storm Sewer installation, installing Str. 12-H and 19-A. Also installed 31 LF of 24” HDPE pipe.
Misc
Informational
05/11/2020
On 4-29-2020. Contractor Earth Works resumed installation of storm line 19 installing 100 LF of 18” HDPE pipe and the end section 19-B.
Misc
Informational
05/11/2020
On Thursday, 4-30-2020. Contractor Earth Works completed the following. 1. Installed Storm Sewer at line #2 Str. 02-B, 02-C & 02-D. Placed approx 200 LF of 18” HDPE pipe and is31 LF of 15” HDPE pipe. 2. On line 8 Str. 08-A, 126 LF 24” HDPE pipe to 08-B thru 08-C Flared in section 60 LF 18” HDPE pipe. 3. Grading Detention ponds between line 9 and line 8. 4. Crew #3 - Boring under 150HWY found 16” abandoned water main. Called designer and am awaiting answer to bore through it.
Misc
Informational
05/11/2020
Contractor Earth Works resumes Storm Sewer installation. Line #5 was installed. Str. 05-C, 05-D and 05-E are installed with approx. 80 LF of 15” HDPE pipe. Crew #2 installed Str. 12-F and 18-A on line 18. 32 LF of 18” HDPE pipe was placed as well.
Misc
Informational
05/11/2020
Earth Works crew resumed installation of the storm sewer for line 15. Also completed some concrete inverts at various structures.
Misc
Informational
05/11/2020
On Friday, 5-08-2020. The contractor Earth Works continued placement of the final storm line #15 placing final Str. And pipe. Contractor also completed small levels of road way grading throughout project.
Misc
Informational
05/11/2020
Friday 5-08-2020. The contractor completed the installation installment of the casing pipe for the proposed 12” water main tap. Contacted our water services department about getting the valves checked prior to the proposed shut later in the week.
Misc
Informational
05/11/2020
On Monday 5-11-2020 Earth works set some box lids throughout project and completed some grading for road way.
Misc
Informational
05/21/2020
On Monday 5-11-2020 Earth works set some box lids throughout project and completed some grading for road way.
Misc
Informational
05/21/2020
On Monday 5-11-2020 Earth works set some box lids throughout project and completed some grading for road way.
Misc
Informational
07/25/2020
On Friday 7-24-2020. Earth Works Excavating poured inverts for the detention structures for the ponds at front of project.
Misc
Informational
01/12/2021
On Monday, 12-28-2020. Earthworks had a sub contractor form and pour the concrete dissipator for the north detention basin.
Water Line - Construction Taps Removed Passed 01/18/2021
Misc
Informational
01/18/2021
On Monday, 1-18-2021 (2) Corp taps were removed and plugged and back filled. This completed all water testing for project.
Install Street and Stop Signs Passed 02/02/2021
Misc
Informational
02/02/2021
On Tuesday, 1-05-2021. All Signage was installed throughout project.
Site Visit Complete 1/30/2020 02/04/2021
Misc
Informational
01/30/2020
I met with the foreman for the Earth Works crew to discuss their plan for the remainder of the project. The crew is going to be working on site prep for the remainder of the week due to the recent weather events. The crew plans on blasting rock next week and installing storm line 12 & Sanitary line D. I will follow up with inspections next week.
Misc
Informational
03/27/2020
Visited project site on Thursday March 26, 2020 and met with John DiMauro to transfer all plans spec’s and information noted for the permanent transfer of the project to myself. Found contractor completing Sanitary installation Line B from MH B7 to MH B8. Today contractor is not working due over night rain that left unfavorable working conditions.
Misc
Informational
05/04/2020
On Friday, 5-01-2020, Contractor Earth Works began boring for the 12” water main tie-in under US 150 Hwy. Contractor encountered a 16” water main that was abandoned. The main was approx. 2” to 3” in the line of the new 12” water main boring location. Kevin Sherrett the design engineer and Steve Robbins of Lee Summit were notified and were present on project site when contractor was directed by the city to cut into the 16” main to make sure the main was abandoned. Line was abandoned and contractor completed installation of the casing insert underneath the roadway.
Misc
Informational
05/06/2020
On Friday, 5-01-2020, Contractor Earth Works began boring for the 12” water main tie-in under US 150 Hwy. Contractor encountered a 16” water main that was abandoned. The main was approx. 2” to 3” in the line of the new 12” water main boring location. Kevin Sherrett the design engineer and Steve Robbins of Lee Summit were notified and were present on project site when contractor was directed by the city to cut into the 16” main to make sure the main was abandoned. Line was abandoned and contractor completed installation of the casing insert underneath the roadway.
Misc
Informational
05/06/2020
On 5-05-2020, Contractor Earth Works Began boring 2nd water main Location at the intersection of W Main St. & HWY 150. The contractor encountered 2 valves and a 12” existing water line not shown on the plans. Water Services was called out to identify what the line was. It was determined the line was abandoned. Steve Robbins also was present for the identification. Contractor was directed to cut through the pipe.
Misc
Informational
05/06/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/06/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/06/2020
On Wednesday, 5-06-2020. Met with Kent and Steve this morning and discussed the Detention basin structures that have not been installed. I spoke with Scott of Earth Works and was reminded that there were issues with the design at the entrance of Cobey Creek drive and 150 Hwy. Kent will speak to Kevin the designer and get back with me.
Misc
Informational
05/07/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/07/2020
On Wednesday, 5-06-2020. Met with Kent and Steve this morning and discussed the Detention basin structures that have not been installed. I spoke with Scott of Earth Works and was reminded that there were issues with the design at the entrance of Cobey Creek drive and 150 Hwy. Kent will speak to Kevin the designer and get back with me.
Misc
Informational
05/07/2020
On Thursday, 5-07-2020. Contractor Earth Works installed the water line casing underneath HWY 150 for the proposed main tap.
Misc
Informational
05/20/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/20/2020
On Wednesday, 5-06-2020. Met with Kent and Steve this morning and discussed the Detention basin structures that have not been installed. I spoke with Scott of Earth Works and was reminded that there were issues with the design at the entrance of Cobey Creek drive and 150 Hwy. Kent will speak to Kevin the designer and get back with me.
Misc
Informational
05/20/2020
On Thursday, 5-07-2020. Contractor Earth Works installed the water line casing underneath HWY 150 for the proposed main tap.
Misc
Informational
05/20/2020
On Wednesday, 5-20-2020. Earth Works installing the 4” under drains for 7 drainage . Also jet roded the 10” and larger sanitary sewers for future testing.
Misc
Informational
05/21/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/21/2020
On Wednesday, 5-06-2020. Met with Kent and Steve this morning and discussed the Detention basin structures that have not been installed. I spoke with Scott of Earth Works and was reminded that there were issues with the design at the entrance of Cobey Creek drive and 150 Hwy. Kent will speak to Kevin the designer and get back with me.
Misc
Informational
05/21/2020
On Thursday, 5-07-2020. Contractor Earth Works installed the water line casing underneath HWY 150 for the proposed main tap.
Misc
Informational
05/21/2020
On Wednesday, 5-20-2020. Earth Works installing the 4” under drains for 7 drainage . Also jet roded the 10” and larger sanitary sewers for future testing.
Misc
Informational
05/21/2020
On Wednesday, 5-06-2020. The contractor Earth Works continued boring and placing the casing underneath HWY 150.
Misc
Informational
05/21/2020
On Wednesday, 5-06-2020. Met with Kent and Steve this morning and discussed the Detention basin structures that have not been installed. I spoke with Scott of Earth Works and was reminded that there were issues with the design at the entrance of Cobey Creek drive and 150 Hwy. Kent will speak to Kevin the designer and get back with me.
Misc
Informational
05/21/2020
On Thursday, 5-07-2020. Contractor Earth Works installed the water line casing underneath HWY 150 for the proposed main tap.
Misc
Informational
05/21/2020
On Wednesday, 5-20-2020. Earth Works installing the 4” under drains for 7 drainage . Also jet roded the 10” and larger sanitary sewers for future testing.
Misc
Informational
08/06/2020
On Monday 8-03-2020. Earthworks worked thru Thursday 8-06-2020 reworking the Sanitary Sewer to remove sags the were discovered by water services.
Misc
Informational
08/12/2020
Earth Works has been resetting rejected “Y’s for Sanitary line D lot 1 - 7 , also laterals were completed from 8-04-2020 through 8-10-2020. During that week approx. 4 “Y” s were reset on line C and 3 sages were fix in the process.
Misc
Informational
08/14/2020
On Monday 8-10-2020. Contractor reset all y’s And laterals for line B from sta. 18+00 to 12+00.
Misc
Informational
08/14/2020
On Thursday, 8-13-2020. Earth Works resumed Y‘S and lateral adjusting on line C. Laterals and Y’s for lots 13,14,15,30,29,&28 were completed.
Misc
Informational
08/14/2020
On Thursday, 8-13-2020. Earth Works resumed Y‘S and lateral adjusting on line C. Laterals and Y’s for lots 13,14,15,30,29,&28 were completed.
Misc
Informational
08/14/2020
On Thursday, 8-13-2020. Earth Works resumed Y‘S and lateral adjusting on line C. Laterals and Y’s for lots 13,14,15,30,29,&28 were completed.
Misc
Informational
08/14/2020
On Friday, 8-14-2020. Earth Works continues to reset Y’s on line C. Lots 27, 26 ,25, 16, &17/ W flowable fill placed over Thursday’s and Friday repairs.
Misc
Informational
08/17/2020
On Monday, 8-17-2020. Earth Works resumed ‘Y‘ adjustments for lots the south side for 13, 14, 15, 16 &17. Lots 25 and 26 were completed on the north side of the main. The ‘Y’ was broken and replaced using (2) straight back furncos to make necessary repairs. (5) persons completed needed repairs and (3) trackhoes.
Misc
Informational
08/18/2020
Earth Works continued to adjust Sanitary Sewer “Y’s” at lot 24,26 18 & 19.
Misc
Informational
08/21/2020
On Thursday, 8-20-2020. Earth Works Excavating Resumed Sanitary Sewer Y adjustments and reinstall of laterals. Lots 20,21,22 & 23 adjusted and installed. Geo Tech Labs were there to take density test for trench back fill. Tech tested each trench in (2) lefts with (2) test per. Contractor worked sub-base to a 95% passing density test on all trenches.
Misc
Informational
08/26/2020
On Friday, 8-21-2020. Contractor Earth Works resumed Sanitary Sewer “y” adjustments and replacement of 4” laterals at lots151,150 & 162. Also Soils compaction test were performed by Geo - Tech Lab. All lateral crossing test passed compaction.
Misc
Informational
08/26/2020
On Monday 8-24-2020. Earth Works completed adjustments of “Y”s on main for lots 161and 149. 3 - man crew
Misc
Informational
08/26/2020
Earth Works completed adjustments for 2 laterals.lots 160 &168
Misc
Informational
08/26/2020
On Wednesday 8-26-2020. Earth Works resumed Y adjusts. Contractor adjusted Y’s and laterals for lots 159 & 147 on Corbin drive
Misc
Informational
08/28/2020
On Thursday, 8-27-2020. Earth Works resumed “Y” adjustments and lateral replacements for lots 157, 158,145, and 146. Contractor also pour Flowable fill for each of the previous connections placed earlier in the week.
Misc
Informational
08/28/2020
On Friday 8-28-2020. Earth Works began back fill of all open lateral lines and main sewers “Y”s. Geo Technologes were here to test at least (2) lifts per lateral. All laterals passed compaction test.
Misc
Informational
09/04/2020
On Wednesday 9-02-2020. Earth Works Excavating resumed “y” adjustments and lateral installs for lot’s 142,143,144,156 &157. Lateral for sta. 20+81 was moved up the line approx. 5 ft. To miss (2) CI’s that would have caused conflict with the lateral installation.
Misc
Informational
09/15/2020
On Thursday, 9-03-2020. Contractor finished remaining laterals for lot’s and placed flowable fill over connections. I also took water samples from line G at sta. 13+05.
Misc
Informational
09/15/2020
On Friday, 9-04-2020. Contractor completed back filling and compaction test were performed by Geo Technical Lab. All testing passed 95% compaction. Did not get results of the water sample day prior but did take a water sample today.
Misc
Informational
09/15/2020
On Tuesday 9-08-2020. Contractor finished compaction of all lateral, sat. 13+10 for line G. Also began clearing for north detention basin.
Misc
Informational
09/15/2020
On Monday, 9-14-2020. Earth Works began 18” Geo Grid overlapping and compacting over laterals installed over roadway.
Misc
Informational
09/17/2020
On Wednesday(9-16-2020) and Thursday(9-17-2020). Earth Works resumed removing Geo Grid and rock base and installed new grid then re-compact rock base.
Misc
Informational
09/25/2020
Earth Works Excavating has each day since 9-17-2020 thru 9-24-2020 performed sub grade prep for base rock. Grading and compaction are completed and contractor has surveyors out to re-stake curb alignment.
Misc
Informational
09/29/2020
On Tuesday, 9-29-2020. Earth Works Excavating dug out north detention basin area for Detention structure reinforced floor slab and poured for tomorrows wall pour. Floor took 3 cys Of concrete
Misc
Informational
09/29/2020
On Tuesday, 9-29-2020. Earth Works completed jetting Sanitary Sewer lines.
Misc
Informational
10/01/2020
On Thursday, 10-01-2020. Earth Works began digging up locations that water services believed the sewer pipe was not pushed in all the way. Found (1) location that appeared to not be homed all the way in. Contractor wants to talk to Water Services and left pipe exposed until he talks with the City.
Misc
Informational
10/15/2020
On Wednesday, 10-07-2020. Got word back from Steve Robbins that Water Service would except the (3) locations were the Sanitary Lines were not homed in all the way. The contractor had exposed (2) of the areas and requested a review of the locations.
Misc
Informational
10/15/2020
On 10-12-2020 to 10-13-2020, all string line was installed for the curb machine placement through out the project.
Misc
Informational
10/15/2020
The contractor has requested Water Service comes out to video camera the Sanitary Sewers. This request was requested on 10-08-2020 but water services has not yet came out to complete the recording.
Misc
Informational
10/19/2020
On Friday, 10-16-2020. Water services performed the video camera for the previously failed Sanitary Sewer and passed all failed prior testing.
Misc
Informational
10/20/2020
On Monday, 10-19-2020. Earthworks Excavating began receiving 48” RCP pipe and neoplasticism DB’s for the north detention basin.
Misc
Informational
11/17/2020
On Tuesday, 11-17-2020. Earth Works Resume mass grading and rock subgrade and compacted throughout project.
Misc
Informational
12/08/2020
On Friday, 12-04-2020. Earth Works Began Finish grading on the north detention basin.
Misc
Informational
12/08/2020
On Monday, 12-07-2020. Earth Works resumed finish grading for the north detention basin. Contractor also resumed grouting CI lids throughout project.
Misc
Informational
12/08/2020
On Tuesday, 12-08-2020. Earth Works resumed finish grading in the North Detention Basin. Contractor also resumed grouting CI lids.
Misc
Informational
12/15/2020
On Monday, 12-15-2020 and Tuesday 12-16-2020. Earth Works resumed grading north Detention Basin. They also installed rip-rap around end sections in the basin.
Misc
Informational
12/16/2020
On Wednesday, 12-16-2020. Earth Works Excavating resumed final grading placing top soil through out the project. Contractor also installed rip-rap at smaller basins at end sections. And last. The questions was asked if they could substitute the lime stone for concrete block for the energy dissipation for the north Detention Basin. Contractor was told to have designer submit a alternate design.
Misc
Informational
12/28/2020
On Monday,12-28-2020. The contractor formed and poured the dissipators’ for the north Detention Basin.
Misc
Informational
01/18/2021
On Tuesday 12-28-2020 Earth Works removed forms from dissapator on North detention basin.
Misc
Informational
02/02/2021
On Tuesday, 2-02-2021. Contractor Concrete Design formed and poured approx. 16 ADA corners.
Misc
Informational
02/04/2021
On Wednesday, 2-03-2021. Concrete Design formed and pour remaining (6) ADA ramps on project. Also punch list was identified and submitted for substantial inspection. And finally, the contractor and the engineer (Kevin Sterrett) were told that there was a water ponding issue at the front entrance of 150 Hwy & Cobey Creek at the east ADA ramp. Engineering will send surveyor to check grades in front of ramp.
Misc
Informational
02/04/2021
On Wednesday, 2-04-2021. Silt fencing contractor installing erosion fencing around Detention ponds.
Misc
Informational
02/24/2021
On Monday, 2-22-2021, The contractor installed the corrected signage and placed the SE designation of the sign names that were originally SW.
Pavement-Surface Passed 03/05/2021
Misc
Informational
11/20/2020
On Thursday, 11-19-2020. Hanarhan Asphalt Began installating Type 5 base on following streets. Corbin, Carter, David and Cobey Creek Dr. Contractor stopped at Jud Rd. Compaction testing was provided by Kansas City testing. Max Density was 148.7 and testing ranged from 95% comp. to 98.0%.
Misc
Informational
11/20/2020
On Friday, 11-20-2020. Hanarhan Asphalt resumed Base lift finishing Cobey Creek dr. And Gillette st.
Curb - Compression Strength Passed 03/05/2021
Misc
Informational
11/10/2020
On Monday, 11-09-2020. Geo Tech Consultants provided Air, slump and cylinder testing for the new curb installation. Air was 7 %, and slump was 1 1/2” and 4 cyl were taken. The 2nd Test taken after 100 yards of concrete were as follows. Air 5.5%, slump 1” and 4 cyl. Where taken.
Misc
Informational
11/11/2020
On Wednesday, 11-11-2020. JK Concrete resumed curb installation. Contractor installed CG-1 curb using curb machine.
Water Line - Construction Inspection Passed 03/05/2021
Misc
Informational
05/27/2020
On Tuesday, 5-26-2020. Contractor Earth Works Preformed a scheduled 12” water main tap beginning at 9:00 am. Water Line D had (1) 12” x 8” tee installed with (1) 8” gate valve (1) 12” butterfly valve and approx. 80 LF of 8” water line placed through the previously installed incasement pipe. Also at sta. 0+00 the contractor installed (1) 12”x12” tee and (3) butterfly valves. All water was restored by 6:00 pm that evening
Misc
Informational
05/27/2020
On Wednesday, 5-27-2020. Earth Works resumed water line installation. At sta. 0+00. Contractor installed tie-in fitting to the tap installed day previous and also installed approx. 90 LF of 12 “ water line.
Misc
Informational
06/03/2020
On Tuesday, 6-02-2020 contractor Earth Works began installation of the 15” water main. Approx 120 LF of water line was installed with (1) valve.
Misc
Informational
06/08/2020
On Tuesday, 6-09-2020. Earth Works (Contractor) resumed 15” and 8”water line installations. Approx. 300’ of water line was installed with 1 hydrant and a host of bends and hardware.
Misc
Informational
06/10/2020
Wednesday, 6-10-2020. A host of Tee’s were installed Sta. 11+58 of line A and 16+10 line A to F 12” to 8”. And last at sta. 1+20 a 8”x8” tee was installed for line D.
Misc
Informational
06/17/2020
Earth Works installed at sta. 14+89, (1) 11.2 bend and at 16+78 (1) 11-2 bend. On line A. Also on line A, contractors placed (1) 12” x 8“Tee and a host of thrust blocks through out the project.
Misc
Informational
06/18/2020
On Thursday, 6-18-2020. Earth Works installed the following. At sta. # 14+49, 14+89, 16+78 of line A (3) 11.25 bends were installed. At sta. 16+78 one 12”x8” tee was installed for line A. And 300 LF 12” pipe was laid for this line. For line G a 8”x*8 tee was installed w? Approx. 200 LF of 8” pipe.
Misc
Informational
06/19/2020
6-19-2020. Contractor installed approx. 140 LF of 12” waterline completing line A.
Misc
Informational
06/22/2020
On Monday, 6-22-2020. Earth Works resumed waterline installation. 8” Line G from sta. 10+00 to 13+00 was installed with all necessary bends. 8” Line F from sta. 0+00 to sta. 3+00 was installed as well. A tee was installed for line F to line G.
Misc
Informational
06/23/2020
On Tuesday, 6-23-2020. Earth Works resumed waterline installation at Line A 133LF of 12” pipe was installed and 250 LF of 8” pipe was installed on line G and finally 350 LF of 8” water line was placed.
Misc
Informational
06/24/2020
On WEDNESDAY 6-24-2020. Earth Works completed installation of the waterline for the Cobey Creek project. Crew #1 completed installation of line F installing 250 LF of 8” waterline
Misc
Informational
06/26/2020
On Thursday, 6-25-2020. Contractor poured remaining thrust blocks on waterline installation. Backfilled waterlines.
Misc
Informational
06/26/2020
On Friday 6-26-2020, contractor aired out waterlines for testing.
Misc
Informational
07/06/2020
On Thursday 7-02-2020. Contractor Earth Works completed air testing of the 12” waterline. 150 lbs of pressure was placed in the line and it held for 2 hrs passing the pressure test.
Misc
Informational
07/06/2020
On Monday, 7-06-2020. Contractor Earth Works resume pressure testing on the 8” waterline. 150 lbs held for 2 hours passing approx. 1,000 ft. Of waterline
Misc
Informational
07/07/2020
On Tuesday, 7-7-2020. Earth Works completed Pressure testing for all of the remaining 8” waterline. 150 lbs of pressure was introduced into the waterline and it held for 2 hours passing the remaining waterline for the project
Misc
Informational
07/09/2020
On Thursday 7-9-2020. Eart Works completed De- Chlorinating waterlines throughout project.
Misc
Informational
10/15/2020
The contractor has completed and passed all water line bacteria testing on this project as of 10-13-2020. There is (1) location on the project that has not passed twice in a row. Sta. 13+05 on line G has not passed. The contractor has chlorinated the line and will retest Monday, 10-19-2020.
Storm - Rip Rap Passed 03/05/2021
Water Line - Thrust Restraint Passed 03/05/2021
Water Line - Fire Hydrant Passed 03/05/2021
Misc
Informational
06/09/2020
On Monday, 6-08-2020. Contractor Earth Works installed (2) Hydrant located at Sta. 5+06 and sta. 5+11 of line A
Misc
Informational
06/09/2020
On Tuesday, 6-09-2020. Contractor resumed installation of water services, installing Hydrant at sta. 3+06 of line D and Sta. 9+53 of line A. Approx. 240 LF of 15” water line was installed as well as 250 LF of 8” water line.
Misc
Informational
06/10/2020
On Wednesday, 6-10-2020. Earth Works resumed installation of water lines.The following hydrants were installed. Hydrant at sta. 0+57 Line C, sta. 13+92 line A along with approx. 800 LF of 12’ & 8” pipe.
Misc
Informational
06/11/2020
On Thursday,6-11-2020. Contractor earth Works resumed water line installations. Hydrants were installed at the following stations. 2+15, 5+ 60 of line G with 400 LF of 8” pipe. Hydrants at sta. 9+53 and 11+58 for line C and approx. 500 LF of 12” pipe was placed.
Misc
Informational
06/15/2020
On Friday, 6-12-2020. Earth Works crews were reduced to (1) crew. The 8” water line was installed from sta. 2+00 thru 6+00 including installation of hydrant at sta. 5+61 on Corbin Drive. Approx. 400 LF of 8” pipe was installed as well.
Misc
Informational
06/15/2020
On Monday, 6-15-2020. Earth Works resumed 8” water line installation. Contractor installed Hydrants at sta.4+11 on line E.
Misc
Informational
06/16/2020
Crew #1 - install 12” water line for line A. At sta.0+05, contractors installed (1) Hydrant
Misc
Informational
06/17/2020
On Wed, 6-17-2020. Earth Works resumed water line installation. Contractor installed hydrant at sta. 13+92 on line A.
Misc
Informational
06/18/2020
On Thursday, 6-18-2020. Earth Works resumed waterline installation of line F at sta 1+48 (1) hydrant was installed.
Misc
Informational
06/19/2020
On Friday, 6-19-2020 Contractor resumed installation of line A 12” waterline. Contractor installed the hydrant at sta.18+28
Misc
Informational
06/23/2020
On Tuesday 6-23-2020. A hydrant was installed for a 12” pipe on line A at sta.18+38 and (1) plug was installed.
Misc
Informational
06/24/2020
On Wednesday, 6-24-2020 Earth Works completed the installation of the final hydrants for this project. Hydrant located at sta. 4+19 of line F was installed and temp hydrant for line G at sta. 13+10. The incasement for this line was also completed and placed at sta. 11+50 for the 8” line under the storm line at that location.
Water Line - Valve Passed 03/05/2021
Misc
Informational
06/09/2020
On Thursday 6-03-2020, Contractor Earth Works installed all valves for line A line for 15” pipe line through station 5+00 and for line B & D through station 4+00.
Misc
Informational
06/10/2020
On Wednesday, 6-10-2020. Earth Works installed the following valves for the water line. Sta. 11+53, 12+43 12” butterfly valves. Sta.0+05 and 0+52 and at 1+ 25 - 8” Gate Valves on line D.
Misc
Informational
06/15/2020
On Monday 6-14-2020. Earth Works installed valves at Hydrant at Sta. 5+25 and 7+78. Also installed valves at 5+20 and a Tee at sta. 7+80. Contractor also installed approx. 280 LF of 8” water line.
Misc
Informational
06/16/2020
On Tuesday, 6-15-2020, contractor installed 12” valves located on line A at sta. 11+53,and a 12+43. A 8” valve for line line C at sta. 2+00 and 2+05 for line C and E. Contractor also installed 100 LF of 12” pipe and 250 LF of 8” pipe.
Misc
Informational
06/17/2020
On Wednesday, 6-17-2020. Contractor installed (1) 12” valve at sta. 16+15 for line A.
Misc
Informational
06/18/2020
On Thursday 6-18-2020. Earth Works placed 12” valve at sta.16+15 on line A.
Misc
Informational
06/19/2020
6-19-2020. Contractor installed 12” valve on line A at sta. 18+33
Misc
Informational
06/23/2020
On.Tuesday 6-23-2020 a valve was installed at sta. 18+33 for line F
Grading/Excavation/Fill Inspection Passed 03/05/2021
Misc
Informational
08/20/2019
AUGUST 20, 2019 Earthworks Excavating has started excavating and grading detention pond on east side of site.
Misc
Informational
09/06/2019
SEPTEMBER 6, 2019 BLASTING Explosive Contractors Inc has been onsite September 3,4,6 2019 blasting the rock underground that Earthworks Excavating kept hitting while installing Sanitary Line A
Misc
Informational
04/28/2020
On Tuesday, 4-28-2020. Contractor Earth Works completed roadway grading on Cobey Creek Drive between David Road and Gillette.
Misc
Informational
05/21/2020
On Tuesday, 4-28-2020. Contractor Earth Works completed roadway grading on Cobey Creek Drive between David Road and Gillette.
Misc
Informational
07/08/2020
On WEDNESDAY, 7-08-2020. Earth Works completed finish grading for total project sub-base and a proof roll was performed that passed all streets at Cobey Creek Sub-division .
Misc
Informational
07/09/2020
On Thursday, 7-09-2020. Earth Works began placement and compaction of AB3 rock sub-base .
Misc
Informational
07/14/2020
On Monday and Tuesday 7-13 and 7-14-2020. Earth Works resumed Sub-base rock fill through-out project and compacted base fill.
Misc
Informational
07/15/2020
On Tuesday, 7-14-2020. Earth Works resumed installation of AB3 Sub-base, and GEO Grid and compacted sub-grade.
Misc
Informational
07/17/2020
On Friday, 7-17-2020. Earth Works Excavating resumed Rock sub-base installation completing 1st. Lift. Curb string line was placed on various locations.
Misc
Informational
07/25/2020
On Friday, 7-24-2020. Earth Works resumed AB3 sub base installation and compacted fill.
Misc
Informational
11/16/2020
On Monday, 11-16-2020, Earth Works continued to perform mass finish grading throughout project. Contractor also graded rock subbase for asphalt.
Misc
Informational
03/09/2021
On Monday, 3-08-2021. Earth Works re-graded the swales for the field inlets. It was determined the grading that was completed prior was not installed correctly. The swales needed to be placed on both sides of the Field inlets and not directly in the mouth of the structures.
Misc
Informational
03/09/2021
On Tuesday, 3-09-2021. The contractor resumed grading at the field inlets for the 100 year flood drainage system.
Misc
Informational
03/10/2021
On Tuesday, 3-09-2021. The contractor resumed grading at the field inlets for the 100 year flood drainage system.
Misc
Informational
03/10/2021
On Wednesday, 3-10-2021. Earth Works finished up the swale grading for the 100 year field inlet swales. The land surveyors were right behind they checking the swale and placing back lot property stakes.
Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 03/05/2021
Misc
Informational
12/06/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Misc
Informational
12/06/2019
DECEMBER 3, 2019 Earthworks Excavation crews have set MH C-1 on the Onsite portion of the project and are installing services along the way. Crews are bringing green wire above grade to indicate where service lines are located.
Misc
Informational
12/06/2019
DECEMBER 4, 2019 Earthworks Excavation is continuing to install sanitary sewer service lines on the onsite portion of the C-Line from MH C-1. Upon arrival, crews were excavating the existing sidewalk in order to continue the C-Line
Misc
Informational
12/06/2019
DECEMBER 5, 2019 Earthworks Excavation continues to install services on the C-Line from MH C-1.
Misc
Informational
12/06/2019
DECEMBER 6, 2019 Geotechnology lab is on site testing the service lines on C-Line Onsite for compaction using a nuclear density gauge. Earthworks Excavation continues to excavate and install sanitary sewer service lines on the C-Line Onsite portion of the project
Misc
Informational
01/08/2020
JANUARY 8, 2020 Earthworks Excavation crews were pouring kickers for wyes on B-5 and B-6 on the onsite portion of the project for service lines
Misc
Informational
04/01/2020
On Wednesday, 4-01-2020 Contractors are excavating and installing 4” service connections between Sanitary Sewer MH,s B-7 and B-8. Services installed are at sta. 16+11/ 70’ long, 16+29 / 10’ long and 16+69 / 70’ long. Contractor is encountered rock and installation is slow moving.
Misc
Informational
04/02/2020
On Wednesday, 4-01-2020 Contractors are excavating and installing 4” service connections between Sanitary Sewer MH,s B-7 and B-8. Services installed are at sta. 16+11/ 70’ long, 16+29 / 10’ long and 16+69 / 70’ long. Contractor is encountered rock and installation is slow moving.
Misc
Informational
04/02/2020
On Thursday, 4-02-2020 Contractor resumes Sanitary Sewer installation working Laterals between MH 7 and MH 8. Laterals at station 16+94 and sta. 17+ 38 were installed. Flowable fill incasement was completed around laterals. Some rock and soil back filling was completed.
Misc
Informational
04/21/2020
Contractor Earthworks resumed Sanitary Sewer installation placing approx 50 LF of 8” Sanitary sewer and (5) Service Lines on Line 1 between MH B-9 and B-10.
Misc
Informational
04/22/2020
On 4-21-2020,Contractor Earthworks resumed Sanitary Sewer installation placing approx 50 LF of 8” Sanitary sewer and (5) Service Lines on Line 1 between MH B-9 and B-10.
Misc
Informational
04/22/2020
On 4-22-2020, contractor Earth Works resumed installation of the 8” Sanitary Sewer with services taps for services between MH B-9 through B-10
Misc
Informational
05/21/2020
On 4-21-2020,Contractor Earthworks resumed Sanitary Sewer installation placing approx 50 LF of 8” Sanitary sewer and (5) Service Lines on Line 1 between MH B-9 and B-10.
Misc
Informational
05/21/2020
On 4-22-2020, contractor Earth Works resumed installation of the 8” Sanitary Sewer with services taps for services between MH B-9 through B-10
Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 03/05/2021
Misc
Informational
12/05/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Misc
Informational
12/05/2019
DECEMBER 3, 2019 Earthworks Excavation crews have set MH C-1 on the Onsite portion of the project and are installing services along the way. Crews are bringing green wire above grade to indicate where service lines are located.
Misc
Informational
12/05/2019
DECEMBER 4, 2019 Earthworks Excavation is continuing to install sanitary sewer service lines on the onsite portion of the C-Line from MH C-1. Upon arrival, crews were excavating the existing sidewalk in order to continue the C-Line
Misc
Informational
12/05/2019
DECEMBER 5, 2019 Earthworks Excavation continues to install services on the C-Line from MH C-1.
Misc
Informational
12/06/2019
DECEMBER 6, 2019 Geotechnology lab is on site testing the service lines on C-Line Onsite for compaction using a nuclear density gauge. Earthworks Excavation continues to excavate and install sanitary sewer service lines on the C-Line Onsite portion of the project
Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 03/05/2021
Misc
Informational
12/04/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Misc
Informational
12/04/2019
DECEMBER 3, 2019 Earthworks Excavation crews have set MH C-1 on the Onsite portion of the project and are installing services along the way. Crews are bringing green wire above grade to indicate where service lines are located.
Misc
Informational
12/04/2019
DECEMBER 4, 2019 Earthworks Excavation is continuing to install sanitary sewer service lines on the onsite portion of the C-Line from MH C-1. Upon arrival, crews were excavating the existing sidewalk in order to continue the C-Line
Misc
Informational
12/05/2019
DECEMBER 5, 2019 Earthworks Excavation continues to install services on the C-Line from MH C-1.
Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 03/05/2021
Misc
Informational
12/03/2019
NOVEMBER 7, 2019 Earthworks Excavation have set Wyes in between MH 4 and MH 5 on the Onsite portion on the B Line and between MH 5 And MH 6. Flowable fill will also be poured today and lines will be back filled on 11/8/19
Misc
Informational
12/03/2019
DECEMBER 3, 2019 Earthworks Excavation crews have set MH C-1 on the Onsite portion of the project and are installing services along the way. Crews are bringing green wire above grade to indicate where service lines are located.
Misc
Informational
12/04/2019
DECEMBER 4, 2019 Earthworks Excavation is continuing to install sanitary sewer service lines on the onsite portion of the C-Line from MH C-1. Upon arrival, crews were excavating the existing sidewalk in order to continue the C-Line
Sanitary Sewer Construction Inspection Passed 03/05/2021
Misc
Informational
11/20/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
11/20/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
11/20/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
11/20/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
11/20/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
11/20/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
11/20/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
11/20/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
11/20/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
11/20/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
11/20/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
11/20/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
11/20/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
11/20/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
11/20/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
11/20/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
11/20/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
11/20/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
11/20/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
11/20/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
11/20/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
11/20/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
11/20/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
11/20/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/20/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Misc
Informational
11/20/2019
NOVEMBER 5, 2019 Earthworks Excavation has set, on the onsite portion of the project, Manhole B-4 and B-5. They are continuing, after backfilling and compacting from B-4 to B-5, to head to B-6.
Misc
Informational
11/20/2019
NOVEMBER 8, 2019 Upon arrival, Earthworks Excavation crews had set MH B-6 on the ONSITE portion of the project. Also, crews finished pouring trench checks with Flowable fill on November 7, 2019
Misc
Informational
11/20/2019
NOVEMBER 14, 2019 Earthworks Excavation crews are excavating and installing Sanitary Sewer line on the ONSITE portion of project. Crew has hit more rock while excavating. Crew has set MH-B6 and are installing pipe toward B-7. MH-B7 is not onsite at this time.
Misc
Informational
11/20/2019
NOVEMBER 15, 2019 Earthworks Excavation is Installing Sanitary Sewer Line on the Onsite portion of the project. The crews have set MH B-6 and are installing pipe toward MH C-1. 3rd party testing lab will be onsite to run compaction test on Monday November 18, 2019 at 1pm. Crews will backfill when Testing lab is on site
Misc
Informational
11/20/2019
NOVEMBER 19, 2019 Earthworks Excavation crews are excavating, and installing Sanitary Line C for services.
Misc
Informational
11/20/2019
NOVEMBER 20, 2019 Earthworks Excavation crew is continuing to excavate, install and back fill sanitary Line C from MH-B6 on the onsite portion of the project
Misc
Informational
11/25/2019
NOVEMBER 25, 2019 Earthworks Excavation is installing Sanitary Line for Services on Line C
Misc
Informational
03/31/2020
I have taken over project from John DiMauro on 3-25-2020. Contractor is rained out onThursday 3-26-2020 and resumed Sanitary installation of 8” PVC at line B-7 thru B-8. Contractor is in total rock and is only installing (2) sections of pipe a day.
Misc
Informational
03/31/2020
Monday, 3-30-2020 Contractor resumes 8’ Sanitary Sewer installation between MH B-7 & B-8. Installed 20LF of Pipe.
Misc
Informational
04/07/2020
On Tuesday, 4-07-2020, Earthworks Excavating continued placement of the 8” Sanitary Sewer between sta.20+00 thru Sta. 21+00. Contractor is encountering rock and has been slowed by is removal.
Misc
Informational
04/08/2020
On Tuesday, 4-07-2020, Earthworks Excavating continued placement of the 8” Sanitary Sewer between sta.20+00 thru Sta. 21+00. Contractor is encountering rock and has been slowed by is removal.
Misc
Informational
04/08/2020
Contractor resumed Sanitary Sewer installation. Completed install of approx. 30LF of 8 “ pipe and also place (1) 70 ft. 6” service line at sta. 22+20. Also backfilled over yesterday’s sewer installation.
Misc
Informational
04/10/2020
Earthworks excavating on 4-10-2020 placed approx. 60 LF of 8” sanitary sewer and (3) laterals located at sta. 19+56, 19+52 and 20+14.
Misc
Informational
04/13/2020
Earthworks excavating on 4-10-2020 placed approx. 60 LF of 8” sanitary sewer and (3) laterals located at sta. 19+56, 19+52 and 20+14.
Misc
Informational
04/13/2020
Heavy weekend rain made Sanitary Sewer Installation a challenge. Earth Works contractor resumed Sanitary Sewer installation and installed 8” sewer from sta. 20+00 thru 21+00 while setting MH B9.
Misc
Informational
04/14/2020
Earthworks excavating on 4-10-2020 placed approx. 60 LF of 8” sanitary sewer and (3) laterals located at sta. 19+56, 19+52 and 20+14.
Misc
Informational
04/14/2020
Heavy weekend rain made Sanitary Sewer Installation a challenge. Earth Works contractor resumed Sanitary Sewer installation and installed 8” sewer from sta. 20+00 thru 21+00 while setting MH B9.
Misc
Informational
04/14/2020
Contractor Earthworks resumed sanitary sewer installation. Contractor installed 4 service line and approx. 60 LF of 8” sewer for lots 157 & 158.
Misc
Corrective Action Required
04/20/2020
On Monday, 4-20-2020, Contractor Earth Works began testing of Sanitary Sewers beginning at MH # B-4. The vacuum for the man hole and the 8” pipe between Str. B-4 and B-5 passed testing. The Mandrel test also passed. Contractor moved to MH # B-5. Vacuum test passed for Manhole but there was debris in the line between B-5 and B-6 and test Failed. Debris was also in the D line. Testing was stopped and the contractor was told to check all of the Sewer lines on the project for blockages before we resumed any more testing.
Misc
Resolved
05/13/2020
Contractor Earth Works Had company come out and jet rod the line that were holding debris.
Misc
Informational
05/13/2020
On 5-13-2020 Contractor Earth Works completed Mandrels for all Sanitary Sewers. All lines passed testing.
Misc
Informational
05/13/2020
On 5-13- 2020, Contractor Earth Works completed Vacuum testing for all installed Sanitary pipe and Man Holes.
Misc
Informational
05/21/2020
On 5-13- 2020, Contractor Earth Works completed Vacuum testing for all installed Sanitary pipe and Man Holes.
Misc
Informational
05/21/2020
On 5-13- 2020, Contractor Earth Works completed Vacuum testing for all installed Sanitary pipe and Man Holes.
Misc
Informational
05/21/2020
On 5-13- 2020, Contractor Earth Works completed Vacuum testing for all installed Sanitary pipe and Man Holes.
Sanitary Sewer - Invert Passed 03/05/2021
Misc
Informational
10/15/2019
SMICO construction poured and formed inverts in manholes 9, 8, 7 and 6.
Sanitary Sewer Construction Inspection Passed 03/05/2021
Misc
Informational
10/17/2019
JULY 15, 2019 Existing Manhole has been approved. Existing Manhole SP-008 @ Sta. 0+00 has been cored, pipe installed and Earthworks Excavating are pouring collars.
Misc
Informational
10/17/2019
AUGUST 5, 2019 @10:40AM Earthworks Excavation is continuing to back fill, excavate, and install Sanitary Line A from MH A3 to MH A4. Crew is currently hitting rock as they excavate.
Misc
Informational
10/17/2019
AUGUST 6, 2019 Earthworks crew is continuing to backfill, excavate and install Sanitary Line A from MH A3 to MH A4.
Misc
Informational
10/17/2019
AUGUST 9, 2019 Earthworks Excavation is continuing to backfill, excavate and Install Sanitary Line A from MH A3 to A4.
Misc
Informational
10/17/2019
AUGUST 12, 2019 Earthworks Excavation crew is continuing to backfill, excavated and install Sanitary Line A from MH A3 to MH A4
Misc
Informational
10/17/2019
AUGUST 12, 2019 Earthworks Excavation has MH A4 bottom portion set.
Misc
Informational
10/17/2019
AUGUST 13, 2019 Inspector issued plans for streets and storm sewer First Plat Phase I to Chris Macy of Earthworks Excavation. Chris was on site clearing and grubbing and repairing silt fence. Chris also wanted to start erosion control for First Plat Phase I. Earthworks Excation pipe crew was running string line to MH A5.
Misc
Informational
10/17/2019
AUGUST 14, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A4 to MH A5.
Misc
Informational
10/17/2019
AUGUST 15, 2019 Earthworks Excavation has hit lots of rock while excavating. No new pipe has been installed on Sanitary Line A
Misc
Informational
10/17/2019
AUGUST 20, 2019 Earthworks Excavating is continuing to backfill, excavate and install Sanitary Line A from Manhole A4 to A5
Misc
Informational
10/17/2019
SEPTEMBER 6, 2019 Earthworks Excavation crews continue to excavate, backfill, and install Sanitary Line A from MH A4 to MH A5. MH A5 was set upon Inspectors arrival.
Misc
Informational
10/17/2019
SEPTEMBER 9, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A5
Misc
Informational
10/17/2019
SEPTEMBER 10, 2019 Earthworks Excavation crews are continuing to backfill, excavate, and install Sanitary Line A. The crew has built a concrete encasement at STA: 14+57 to 14+77. Concrete to be poured 9/10/19.
Misc
Informational
10/17/2019
SEPTEMBER 12, 2019 Earthworks Excavation is continuing to excavate, backfill, and install Sanitary Line A. MH A6 has been set and crew continues to install the Sanitary sewer line
Misc
Informational
10/17/2019
SEPTEMBER 16, 2019 Earthworks Excavation crews continue to install, backfill and excavate for Sanitary Line A from MH A6.
Misc
Informational
10/17/2019
SEPTEMBER 18, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A6 to MH A7
Misc
Informational
10/17/2019
SEPTEMBER 20, 2019 Earthworks Excavation continues to install Sanitary Line A from MH A7
Misc
Informational
10/17/2019
SEPTEMBER 24, 2019 Earthworks Excavation is continuing to backfill, excavate and install Sanitary Line A from MH A7
Misc
Informational
10/17/2019
SEPTEMBER 26, 2019 Earthworks Excavation continues to excavate, install and back from Sanitary Line A from MH A7
Misc
Informational
10/17/2019
SEPTEMBER 27, 2019 Earthworks excavation is continuing to excavate, backfill, and install Sanitary Line A from MH A7
Misc
Informational
10/17/2019
SEPTEMBER 30, 2019 Earthworks Excavation crew was setting MH A8 as Inspector arrived on site. Crew continues to backfill as they go along Sanitary Line. The correct amount of clean gravel was and has been set as crews go down sanitary line.
Misc
Informational
10/17/2019
OCTOBER 8, 2019 Earthworks Excavation crews have set the last MH on the offsite portion of the project. Crews are backfilling and compacting soil between MH A8 and A9.
Misc
Informational
10/17/2019
OCTOBER 14, 2019 Earthworks Excavation Crews have set MH A9 in the offsite and now are excavating and installing MH B1 on the onsite. They are also continuing to backfill as they go. There is the appropriate amount of gravel on top and bottom of pipe.
Misc
Informational
10/17/2019
OCTOBER 17, 2019 Earthworks Excavation continues to excavate, install, and back filled Sanitary Sewer Lines B from MH B-1 to B-2.
Misc
Informational
11/04/2019
NOVEMBER 4, 2019 Earthworks Excavation crews are continuing to install Sanitary sewer line. The crews are on the onsite portion of the project. Manhole B-4 has been set and crews are excavating, and installing 8” PVC pipe toward B-5.
Storm - Swales Passed 03/05/2021
Misc
Informational
03/05/2021
On Monday 3-01-2021. Earth Works finished all swales through out project.
Misc
Informational
09/27/2021
On Monday, 9-27-2021. The contractor completed the swale engineered by the designer east of Corbin rd. Contractor also installed rip-rap at spillway. On Tuesday, 9-28-2021. Contractor installed 6’ straw swale bottom and completed all clean up.
Water Line - Coliform Test 2 Passed 03/05/2021
Misc
Informational
03/05/2021
On Monday, 1-18-2021. Water samples for the last section of water lines passed bacteria test.
Misc
Informational
04/29/2021
On Thursday test
Storm Sewer Construction Inspection Partial 08/30/2021
Misc
Informational
03/17/2020
The Earthworks Crew was on site working on Storm Sewer Line 01. The crew installed storm box 01-C and was working on installing the HDPE pipe between 01-C and 01-D. The collar for box 01-C was installed and photos of the work are uploaded into the system. The crew plans to continue the storm line install today but with a rain event in the forecast they will potentially off tomorrow.
Misc
Informational
08/30/2021
On Wednesday through Friday, 8-25-2021 to 8-27-2021. A contractor (Clifford) worked re digging the swales at the properties that the TCO was held on. On Monday, 8-30-2021. Contractor (Clifford) resumed excavating for new swales and (2) Field inlets were cut down to meet new design elevations. On Thursday, 9-02-2021. The contractor resumed excavation for the swales. On Tuesday, 9-07-2021. Contractor resumed swale installation. On Wednesday, 9-08-2021. The Contractor resumed swale installation and has stop short of the 0+00 sta. The contractor has stopped at box 01-D which is about 280 LF short from the beginning of the swale. Contractor was told to only complete the swale at box 01-D.
Storm Sewer Construction Inspection Passed 11/02/2021
Misc
Informational
08/30/2021
The Earthworks Crew was on site working on Storm Sewer Line 01. The crew installed storm box 01-C and was working on installing the HDPE pipe between 01-C and 01-D. The collar for box 01-C was installed and photos of the work are uploaded into the system. The crew plans to continue the storm line install today but with a rain event in the forecast they will potentially off tomorrow.
Misc
Informational
08/30/2021
On Wednesday through Friday, 8-25-2021 to 8-27-2021. A contractor (Clifford) worked re digging the swales at the properties that the TCO was held on.
Water Line - Valve Not Ready 08/24/2022
Misc
Informational
06/09/2020
On Thursday 6-03-2020, Contractor Earth Works installed all valves for line A line for 15” pipe line through station 5+00 and for line B & D through station 4+00.
Storm - Outlet Structure Not Ready 08/24/2022
Misc
Informational
10/01/2020
On Tuesday, 9-29-2020. Earth Works Set forms, tied steel and poured base for north Detention pond Structure.
Documents & Images
Date Uploaded File Type Document Name
04/25/2019 Receipt Receipt for transaction: 2019-001608
08/01/2019 Receipt Receipt for transaction: 2019-005251
08/04/2019 JULY 15, 2019 Existing Manhole SP-008 STA. 0+00
08/04/2019 JULY 15, 2019 Existing Manhole SP-008 Sta. 0+1
08/04/2019 JULY 16, 2019 Plugged Manhole
08/04/2019 JULY 16, 2019 Plugged Manhole0
08/04/2019 JULY 16, 2019 Plugged Manhole1
08/04/2019 JULY 17, 2019 Sanitary Line A from Existing SP-008 MH
08/04/2019 JULY 18, 2019 San. Line A Existing to A1
08/04/2019 JULY 19, 2019 Manhole A1
08/04/2019 JULY 24, 2019 MH A1 TO MH A2
08/04/2019 JULY 25, 2019 MH A1 TO MH A2
08/04/2019 JULY 25, 2019 MH A1 TO MH A3
08/04/2019 JULY 26, 2019 MH A2 to MH A3
08/04/2019 JULY 29, 2019 Sanitary Line A MH A2 to MH A3
08/04/2019 JULY 30, 2019 Cont. Sanitary Line A from MH A2 to MH A3
08/04/2019 JULY 31, 2019 Sanitary Line A MH 3 Set.
08/04/2019 AUGUST 1, 2019 Sanitary Line A MH A3 to MH A4
08/04/2019 Letter INSPECTION SUMMARY
08/04/2019 Letter INSPECTION SUMMARY
08/04/2019 Letter INSPECTION SUMMARY
08/05/2019 AUGUST 5, 2019 Sanitary Line A from MH A3 to MH A4
08/05/2019 Letter INSPECTION SUMMARY
08/06/2019 AUGUST 6, 2019 Sanitary Line A from MH A3 to MH A4
08/06/2019 Letter INSPECTION SUMMARY
08/09/2019 AUGUST 9, 2019 San. Line A MH A3 to A4
08/09/2019 Letter INSPECTION SUMMARY
08/12/2019 AUGUST 12, 2019 San. Line A from MH A3 to MH A4
08/12/2019 Letter INSPECTION SUMMARY
08/12/2019 AUGUST 12, 2019 MH A4 Bottom portion set.
08/12/2019 Letter INSPECTION SUMMARY
08/13/2019 AUGUST 12, 2018 San. Line A MH A4 to MH A5 Stringline
08/13/2019 Letter INSPECTION SUMMARY
08/14/2019 AUGUST 13, 2019 San. Line A MH A4 to MH A5
08/14/2019 Letter INSPECTION SUMMARY
08/15/2019 Letter INSPECTION SUMMARY
08/20/2019 AUGUST 20, 2019 DETENTION POND
08/20/2019 Letter INSPECTION SUMMARY
08/20/2019 AUGUST 20, 2019. Sanitary Line A MH A4 to MH A5
08/20/2019 Letter INSPECTION SUMMARY
08/28/2019 AUGUST 28, 2019 DETENTION POND
08/28/2019 AUGUST 28, 2019 DETENTION POND0
08/28/2019 Letter INSPECTION SUMMARY
08/28/2019 AUGUST 28, 2019 Sanitary Line A from MH A4 to MH A5
08/28/2019 Letter INSPECTION SUMMARY
09/06/2019 SEPTEMBER 6, 2019 MH A4 to MH A5
09/06/2019 Letter INSPECTION SUMMARY
09/06/2019 SEPTEMBER 6, 2019 BLASTING SANITARY LINE A
09/06/2019 Letter INSPECTION SUMMARY
09/09/2019 SEPTEMBER 9, 2019 SANITARY LINE A FROM MH A5
09/09/2019 Letter INSPECTION SUMMARY
09/10/2019 Letter INSPECTION SUMMARY
09/12/2019 SEPTEMBER 12, 2019 SANITARY LINE A MH A6
09/12/2019 Letter INSPECTION SUMMARY
09/12/2019 Letter INSPECTION SUMMARY
09/16/2019 SEPTEMBER 16, 2019 SANITARY LINE A MH A6
09/16/2019 Letter INSPECTION SUMMARY
09/18/2019 SEPTEMBER 18, 2019 SANITARY LINE A from MH A6 to MH A7
09/18/2019 Letter INSPECTION SUMMARY
09/19/2019 Letter INSPECTION SUMMARY
09/19/2019 SEPTEMBER 19, 2019 CLEAN UP
09/19/2019 Letter INSPECTION SUMMARY
09/20/2019 SEPTEMBER 20, 2019 SANITARY LINE A MH A7
09/24/2019 SEPTEMBER 24, 2019 SANITARY LINE A MH A7 AND ON
09/24/2019 Letter INSPECTION SUMMARY
09/24/2019 Letter INSPECTION SUMMARY
09/26/2019 SEPTEMBER 26, 2019 SANITARY LINE A from MH A7
09/26/2019 Letter INSPECTION SUMMARY
09/26/2019 Letter INSPECTION SUMMARY
09/27/2019 SEPTEMBER 27, 2019 SANITARY LINE A from MH A7
09/27/2019 Letter INSPECTION SUMMARY
09/30/2019 SEPTEMBER 30, 2019 SANITARY LINE A setting MH A 8
09/30/2019 Letter INSPECTION SUMMARY
10/09/2019 OCTOBER 8, 2019 SANITARY LINE A MH A9
10/09/2019 Letter INSPECTION SUMMARY
10/09/2019 OCTOBER 8, 2019 GRADING AND EXCAVATING
10/09/2019 Letter INSPECTION SUMMARY
10/14/2019 OCT 14, 2019 FROM MH A9 OFFSITE TO MH B1 ONSITE
10/14/2019 Letter INSPECTION SUMMARY
10/15/2019 OCTOBER 15, 2019. INVERTS
10/15/2019 Letter INSPECTION SUMMARY
10/17/2019 Letter INSPECTION SUMMARY
11/04/2019 NOVEMBER 4, 2019 Onsite Manhole B-4 toward B-5
11/04/2019 Letter INSPECTION SUMMARY
11/05/2019 NOVEMBER 5, 2019 Onsite B-4 to B-5
11/05/2019 Letter INSPECTION SUMMARY
11/07/2019 NOVEMBER 7, 2019 Installation of Wyes
11/07/2019 NOVEMBER 7, 2019 Trench Checks for Wyes
11/07/2019 Letter INSPECTION SUMMARY
11/07/2019 Letter INSPECTION SUMMARY
11/08/2019 NOVEMBER 8, 2019 MH B-6 SET
11/08/2019 NOVEMBER 8, 2019 MH B-6 SET0
11/08/2019 Letter INSPECTION SUMMARY
11/14/2019 NOVEMBER 14, 2019 MH B-6 TOWARD MH B-7
11/14/2019 Letter INSPECTION SUMMARY
11/15/2019 NOVEMBER 15, 2019 ONSITE MH-B6 toward MH C-1
11/15/2019 Letter INSPECTION SUMMARY
11/18/2019 November 18, 2019 Proctor
11/18/2019 November 18, 2019 Proctor0
11/18/2019 November 18, 2019 Proctor1
11/18/2019 November 18, 2019 Proctor2
11/18/2019 November 18, 2019 Density Testing
11/18/2019 Letter INSPECTION SUMMARY
11/19/2019 NOVEMBER 19, 2019 Sanitary Service Line C
11/19/2019 Letter INSPECTION SUMMARY
11/20/2019 NOVEMBER 20, 2019 SANITARY LINE C ONSITE
11/20/2019 Letter INSPECTION SUMMARY
11/25/2019 November 25 2018 Service Line C
11/25/2019 Letter INSPECTION SUMMARY
12/03/2019 DECEMBER 3, 2019 MH C-1 and services set
12/03/2019 Letter INSPECTION SUMMARY
12/03/2019 Letter INSPECTION SUMMARY
12/05/2019 DECEMBER 5, 2019 C-LINE SERVICES ONSITE
12/06/2019 DECEMBER 6, 2019 Density Testing C-Line Onsite
01/30/2020 Letter INSPECTION SUMMARY
03/17/2020 Letter INSPECTION SUMMARY
03/17/2020 Storm Box 01-C
03/17/2020 Storm Box 01-C0
05/20/2020 Receipt Receipt for transaction:2020-002268
05/21/2020 Approved CobeyCreek-Water - 05.21.2020
07/08/2020 Letter INSPECTION SUMMARY
07/08/2020 Letter INSPECTION SUMMARY
07/20/2020 Cobey Creek Letter
08/06/2020 Approved Plans Cobey Creek Phase I - South Detention Basin Plan and Profile Revision - Approved 8.6.20
08/06/2020 Approved Plans Cobey Creek Phase I - South Detention Outlet Structure Revision - Approved 8.6.20
08/28/2020 Approved Plans Cobey Creek North Detention Basin Plan and Profile Sheet 30 Revision Approved 8.28.20
08/28/2020 Approved Plans Cobey Creek North Detention Basin Outlet Structure Details Sheet 43A Revision Approved 8.28.20
11/04/2020 Approved Plans APPROVED FULL SET St/Stm/'MDP
11/11/2020 Letter INSPECTION SUMMARY
11/11/2020 Letter INSPECTION SUMMARY
12/23/2020 Approved Plans Str & Stm - Detention Outlet Detail Rev Approved 12.23.20
01/07/2021 Letter DE-Permit
02/26/2021 CobeyCreek-Water-Asbuilts-20210216
02/26/2021 COBEY CREEK PHASE I SANITARY ASBUILTS 2.26.21
03/17/2021 Cobey Creek, Phase 1-MDNR SOWC-Sanitary-Signed
03/17/2021 REJECTED Sanitary ASBUILT 030521
03/17/2021 REJECTED St/Stm/MDP AS-BUILTS
03/17/2021 TEMP EASEMENT
03/17/2021 DEFECTIVE PRIVATE EASEMENT
04/20/2021 WO#1EC2579 - City of Lee's Summit
04/20/2021 WO#1ED0079 - City of Lees Summit
04/29/2021 Letter INSPECTION SUMMARY
04/29/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
08/25/2021 Approved Plans APPROVED Cobey Creek Diversion Swale and MDP Revision Approved 8.25.21
08/30/2021 Letter INSPECTION SUMMARY
08/30/2021 Letter INSPECTION SUMMARY
09/27/2021 Letter INSPECTION SUMMARY
08/25/2021 Approved Plans APPROVED Cobey Creek Diversion Swale and MDP Revision Approved 8.25.21
11/08/2021 Letter INSPECTION SUMMARY
04/07/2022 Cobey Creek On-Site Full Substantial Completion
04/07/2022 Cobey Creek On-Site Punch List
04/07/2022 Cobey Creek1st Plat Punch List
04/12/2022 Maintenance Bond - water - Cobey Creek
04/12/2022 Maintenance Bond - storm - Cobey Creek
04/12/2022 Maintenance bond - sanitary - Cobey Creek
08/10/2022 final affidavit - Cobey Creek
08/10/2022 maintenance bond - streets - Cobey Creek
08/23/2022 Letter DE-Certificate of Final Acceptance (Commercial)
08/24/2022 Letter Cobey Creek Final Acceptance
07/18/2023 Plans ACCEPTED RECORD DWG
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
