Permit Application Status

PRSITE20201955

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSITE20201955
Development - Site
Final Completion
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
SOCCER COMPLEX PRIVATE PARKING LOT, STORM SEWER, WATER AND SANITARY SEWER
07/15/2020
08/05/2020
11/06/2024
Locations
Contacts
CITY OF LEES SUMMIT, Address:PO BOX 1600
CLARKSON CONSTRUCTION COMPANY, Address:P O BOX 34315, Phone:(816) 483-8800
PBAJ MANAGEMENT, LLC, Address:801 NW COMMERCE DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 07/15/2020 05/12/2023
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110068-Storm Fee $21,588.90 $21,588.90 Paid 08/03/2020
9110081-Paved Surface Inspection Fee $95,074.17 $95,074.17 Paid 04/13/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $70.00 $70.00 Paid 04/13/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $45.00 $45.00 Paid 04/13/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 04/13/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 04/13/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $215.00 $215.00 Paid 04/13/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Storm - Outlet Structure Partial 01/18/2021
Misc
Informational
01/18/2021

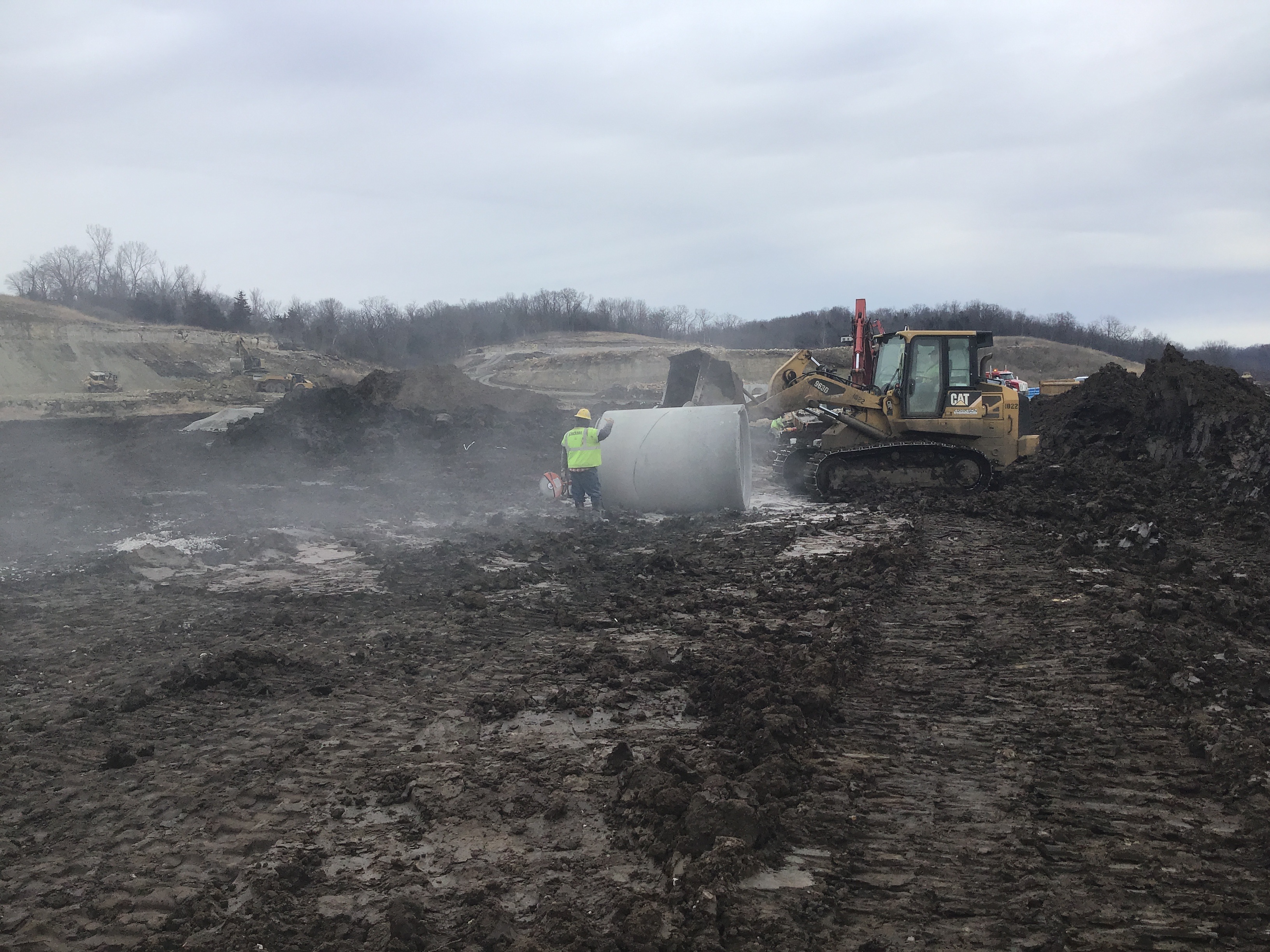

1/18/21 Monday MLK Day Contractor installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work.
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor ( Clarkston) has crew installing RCP pipe & structure on Line 700 and HDPE corrugated pipe & structure on Line 2200.

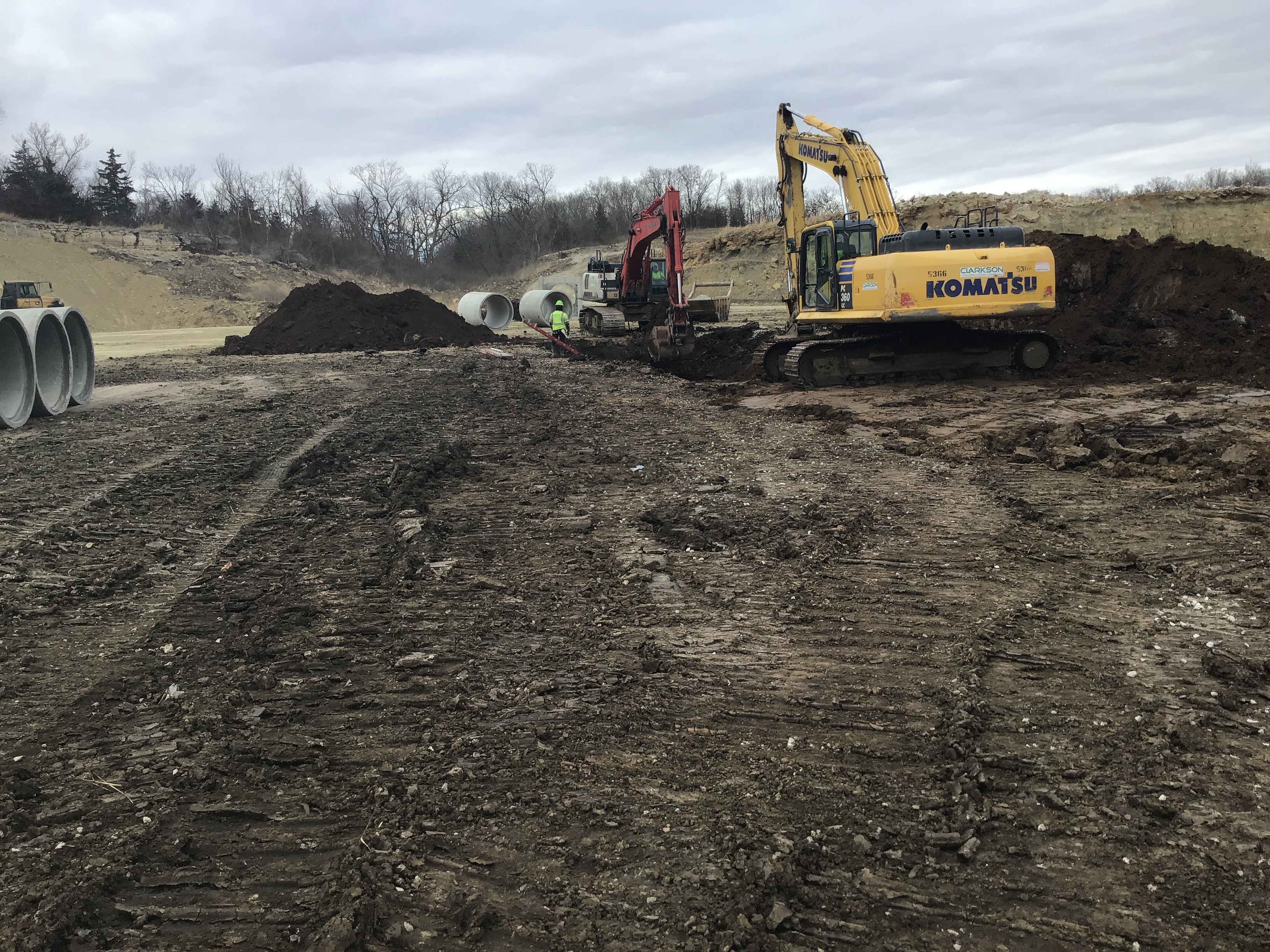

Storm - Outlet Structure Partial 01/19/2021
Misc
Informational
01/18/2021
1/18/21 Monday MLK Day Contractor installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work.
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Storm - Outlet Structure Partial 01/20/2021
Misc
Informational
01/19/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
01/20/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Storm - Outlet Structure Partial 01/21/2021
Misc
Informational
01/20/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
01/20/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
01/20/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
01/21/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Storm - Outlet Structure Partial 02/02/2021
Misc
Informational
01/21/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
01/21/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
01/21/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
01/21/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.

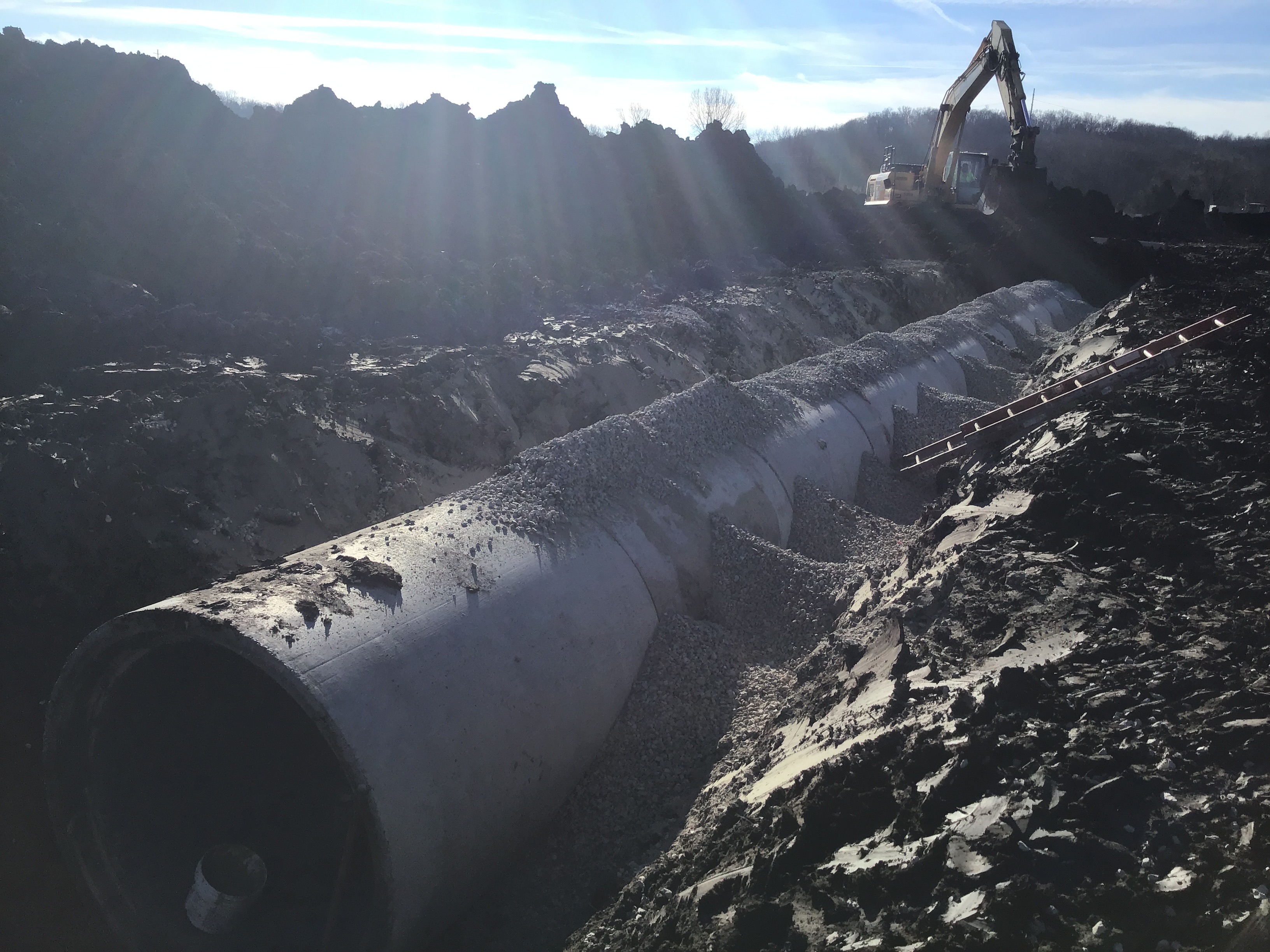

Storm - Outlet Structure Partial 02/03/2021
Misc
Informational
02/02/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/02/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/02/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/02/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/03/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Storm - Outlet Structure Partial 02/05/2021
Misc
Informational
02/03/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/03/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/03/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/03/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/03/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/03/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
02/05/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Storm - Outlet Structure Partial 02/23/2021
Misc
Informational
02/05/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/05/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/05/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/05/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/05/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/05/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
02/05/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Misc
Informational
02/23/2021
2/22/21 Monday Contractor began to install storm structure 2205C and 2206 up to 2207 with 15” HDPE. Contractor moved to storm line 1400 where approximately 132’ of 30” of HDPE was installed out of 1402 Grate Inlet two 1403 Grate Inlet. Approximately 40’ of 24” HDPE was installed from 1403 Grate Inlet to 1404 Grate inlet. Contractor installed 20’ of 24” HDPE passed 1404 Grate Inlet structure then stop for the day.
Storm - Outlet Structure Partial 02/24/2021
Misc
Informational
02/23/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/23/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/23/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/23/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/23/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/23/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
02/23/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Misc
Informational
02/23/2021
2/22/21 Monday Contractor began to install storm structure 2205C and 2206 up to 2207 with 15” HDPE. Contractor moved to storm line 1400 where approximately 132’ of 30” of HDPE was installed out of 1402 Grate Inlet two 1403 Grate Inlet. Approximately 40’ of 24” HDPE was installed from 1403 Grate Inlet to 1404 Grate inlet. Contractor installed 20’ of 24” HDPE passed 1404 Grate Inlet structure then stop for the day.
Misc
Informational
02/24/2021
2/24/21 Wednesday Tuesday 2/23/21 Contractor installed 168 of 12” HDPE between 1404 & 1405 then installed 15’ of 12” HDPE then Grate Inlet 1406 and 34’ of 12” HDPE then Grate Inlet 1407. Contractor is working on Line # 700 contractor has also poured collars and inverts on storm lines.
Storm - Outlet Structure Partial 02/25/2021
Misc
Informational
02/24/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/24/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/24/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/24/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/24/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/24/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
02/24/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Misc
Informational
02/24/2021
2/22/21 Monday Contractor began to install storm structure 2205C and 2206 up to 2207 with 15” HDPE. Contractor moved to storm line 1400 where approximately 132’ of 30” of HDPE was installed out of 1402 Grate Inlet two 1403 Grate Inlet. Approximately 40’ of 24” HDPE was installed from 1403 Grate Inlet to 1404 Grate inlet. Contractor installed 20’ of 24” HDPE passed 1404 Grate Inlet structure then stop for the day.
Misc
Informational
02/24/2021
2/24/21 Wednesday Tuesday 2/23/21 Contractor installed 168 of 12” HDPE between 1404 & 1405 then installed 15’ of 12” HDPE then Grate Inlet 1406 and 34’ of 12” HDPE then Grate Inlet 1407. Contractor is working on Line # 700 contractor has also poured collars and inverts on storm lines.
Misc
Informational
02/25/2021
2/25/21 Thursday Contractor installed the end section on Line 700 with 1- 8’ piece of 60” RCP yesterday 2/24/21. Update will done later for toady.
Misc
Informational
02/25/2021
2/25/21 Thursday Contractor poured collar on storm line 700 at head wall/ end section poured collars & inverts on 1400 & 2200 storm lines.
Site Visit Partial 03/01/2021
Misc
Informational
03/01/2021

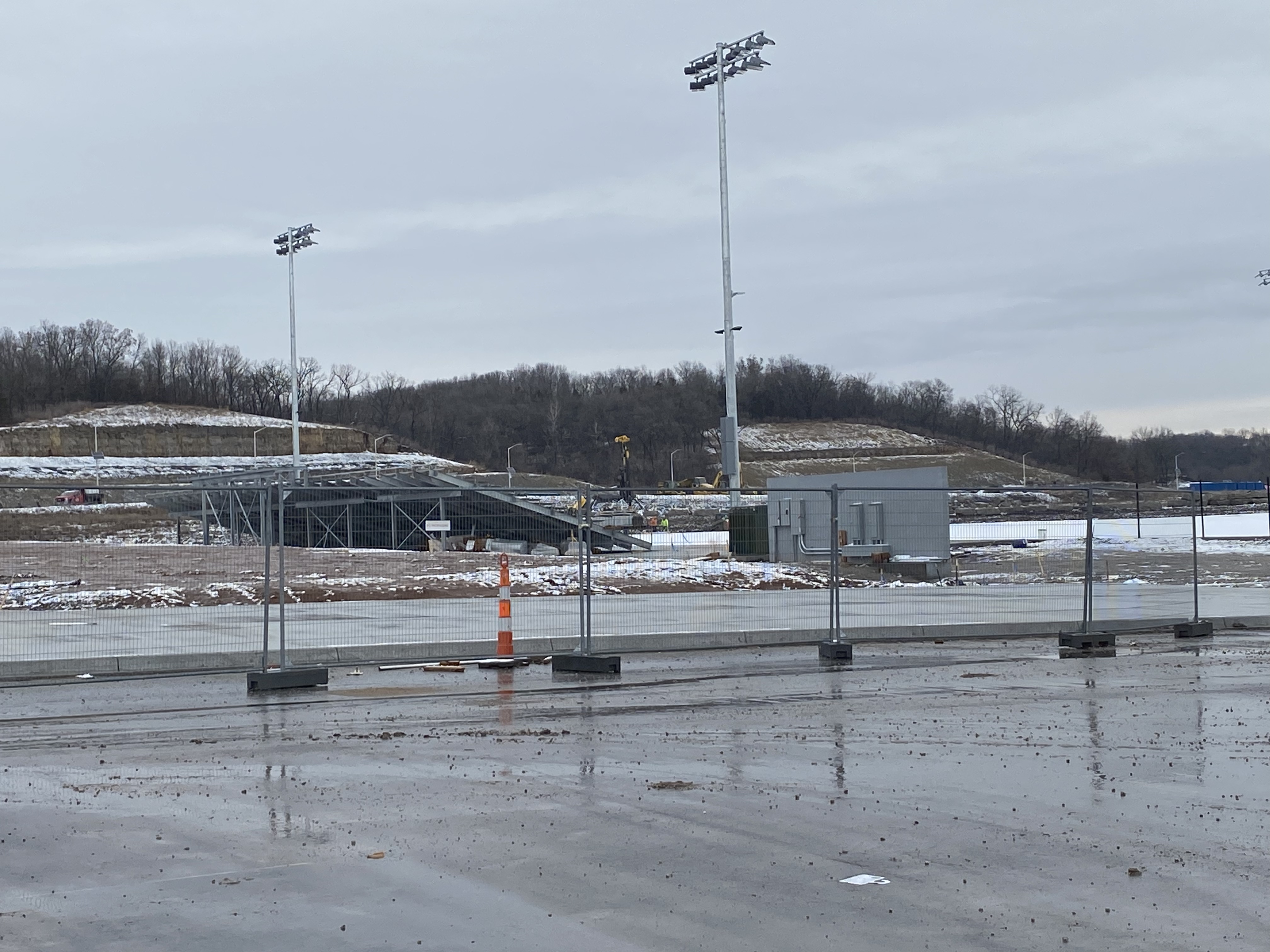

Storm Sewer was delivered to site and excavation was continued.
Storm - Outlet Structure Partial 03/08/2021
Misc
Informational
02/25/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
02/25/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
02/25/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
02/25/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
02/25/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
02/25/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
02/25/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Misc
Informational
02/25/2021
2/22/21 Monday Contractor began to install storm structure 2205C and 2206 up to 2207 with 15” HDPE. Contractor moved to storm line 1400 where approximately 132’ of 30” of HDPE was installed out of 1402 Grate Inlet two 1403 Grate Inlet. Approximately 40’ of 24” HDPE was installed from 1403 Grate Inlet to 1404 Grate inlet. Contractor installed 20’ of 24” HDPE passed 1404 Grate Inlet structure then stop for the day.
Misc
Informational
02/25/2021
2/24/21 Wednesday Tuesday 2/23/21 Contractor installed 168 of 12” HDPE between 1404 & 1405 then installed 15’ of 12” HDPE then Grate Inlet 1406 and 34’ of 12” HDPE then Grate Inlet 1407. Contractor is working on Line # 700 contractor has also poured collars and inverts on storm lines.
Misc
Informational
02/25/2021
2/25/21 Thursday Contractor installed the end section on Line 700 with 1- 8’ piece of 60” RCP yesterday 2/24/21. Update will done later for toady.
Misc
Informational
03/08/2021

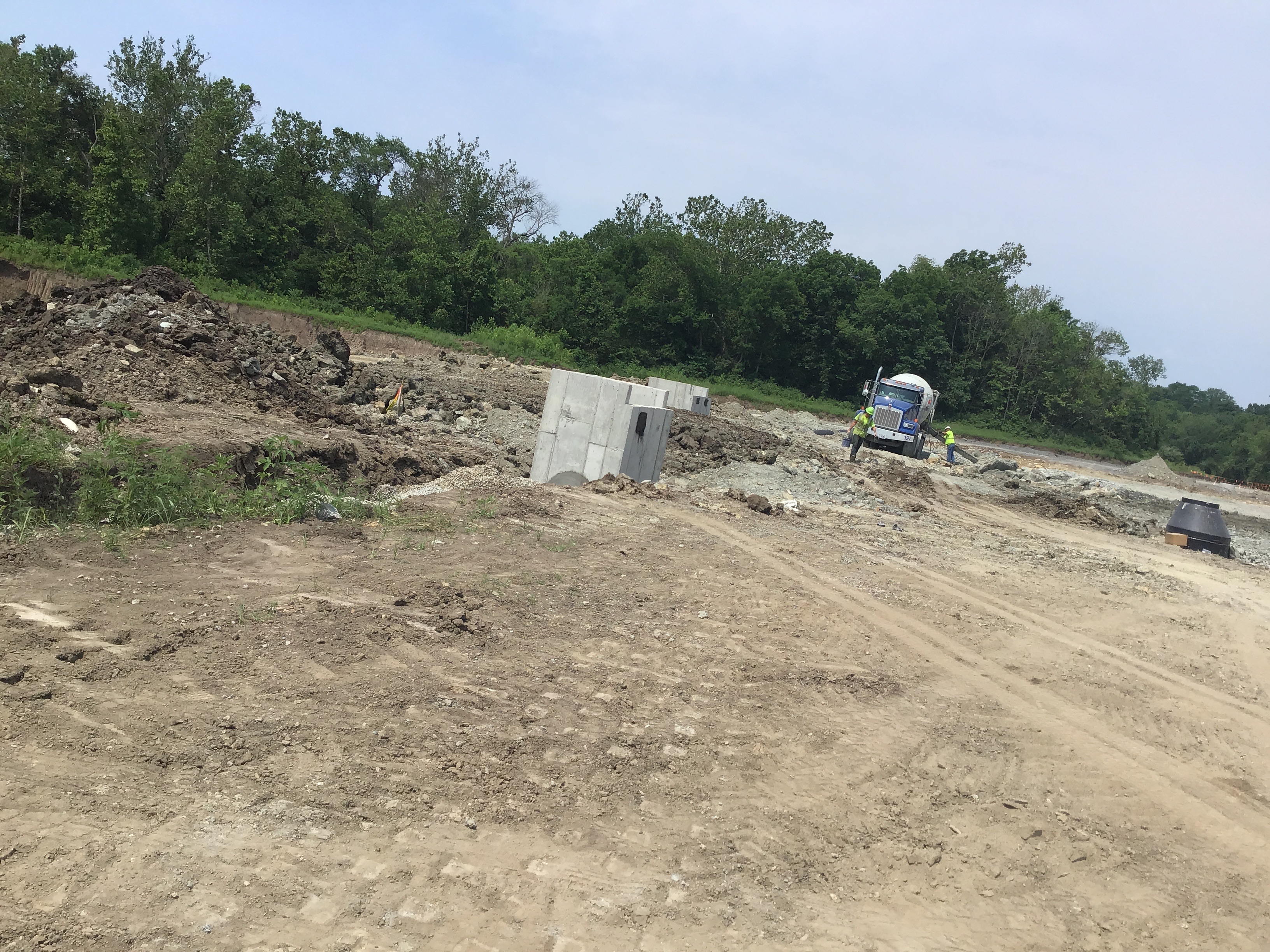

3/8/21 Monday Contractor ( Darron of Clarkston) worked on installation of Line 2600. Installed approximately 113’ of 18” RCP to Curb Inlet ( CI ) 2601 & 60” of 18” RCP after the structure .
Storm - Outlet Structure Partial 04/19/2021
Misc
Informational
03/08/2021
1/18/21 Monday MLK Day Contractor (Clarkson Greg Crew) installed approximately 192’ of 60” RCP on Line 700 1/14/21 Thursday. Today approximately 135’ of 60” RCP and structure 705 10’x5’ Junction Box . Contractor is continuing to install 60” RCP after 705 Junction Box. Contractor installed approximately 40’ of 60” RCP out of the Structure 705 to end the days work. Contractor (Clarkson Darren Crew) installed
Misc
Informational
03/08/2021
1/19/21 Tuesday Contractor crews working on storm Lines 700 & 2200. Pictures of RCP are Line 700 & HDPE are Line 2200. Overview of the days actives will be done later.
Misc
Informational
03/08/2021
1/20/21 Wednesday Contractor (Clarkson Greg Crew) projection are to finish the installation of pipe on Line 700. Collars were poured for 706 and invert for 705 concrete scheduled for later 3:00PM to pour invert for 706 and collars for 704. 707 foundation structure will be installed today. Contractor (Clarkson Darren Crew) installed approximately 242 of of 36” HDPE force to stop because of problems with structure 2203. Contractor moved to Line 1400 and installed Grate Inlet 1402 and installed out of structure, approximately 80’ of 30” HDPE pipe. Collars were poured at 2202 Grate Inlet.
Misc
Informational
03/08/2021
1/21/21 Thursday Contractor Clarkson worked on Lines 700, 1300 & 1400. Collars and inverts were completed on on storm Line 700. Lines 1300 approximately 132’ of 24” HDPE was installed up to proposed structure 1301. Collars & inverts were poured at the storm connection of 1300 to & Structure 704 as-per project plans. Collars and invert poured on Structure 1401. On 701 & 702 invert were poured also Collar was poured on 707.
Misc
Informational
03/08/2021
2/2/21 Tuesday Contractor Clarkson worked on Lines 705 to 901 HDPE storm pipe, & 1900 to 1901 as-per project plans 42” HDPE storm pipe.
Misc
Informational
03/08/2021
2/3/21 Wednesday Contractor (Clarkson) poured invert & collars 901, collar 1403, and toe walls 1900 & 2200. The contractor installed structure 2203.
Misc
Informational
03/08/2021
2/5/21 Friday Contractor (Clarkson) installed 44’ of 36” HDPE from 2203 to 2204, 30” HDPE from 2204 to 2205, and 15” HDPE from 2205 to 2205C.
Misc
Informational
03/08/2021
2/22/21 Monday Contractor began to install storm structure 2205C and 2206 up to 2207 with 15” HDPE. Contractor moved to storm line 1400 where approximately 132’ of 30” of HDPE was installed out of 1402 Grate Inlet two 1403 Grate Inlet. Approximately 40’ of 24” HDPE was installed from 1403 Grate Inlet to 1404 Grate inlet. Contractor installed 20’ of 24” HDPE passed 1404 Grate Inlet structure then stop for the day.
Misc
Informational
03/08/2021
2/24/21 Wednesday Tuesday 2/23/21 Contractor installed 168 of 12” HDPE between 1404 & 1405 then installed 15’ of 12” HDPE then Grate Inlet 1406 and 34’ of 12” HDPE then Grate Inlet 1407. Contractor is working on Line # 700 contractor has also poured collars and inverts on storm lines.
Misc
Informational
03/08/2021
2/25/21 Thursday Contractor installed the end section on Line 700 with 1- 8’ piece of 60” RCP yesterday 2/24/21. Update will done later for toady.
Misc
Informational
03/08/2021
3/8/21 Monday Contractor ( Darron of Clarkston) worked on installation of Line 2600. Installed approximately 113’ of 18” RCP to Curb Inlet ( CI ) 2601 & 60” of 18” RCP after the structure .
Misc
Informational
04/19/2021
4/19/21 Monday Contractor (Clarkson - Gregg crew) worked on storm Line 700 from structure 707 to 708 48” RCP. Side Note : Inspector has not received plans have that detail installation This portion of storm Line 700. Inspector will contact supervisor to obtain project plans. 5/24/21 Monday Contractor (Clarkson - Gregg crew) installed 72’ of 24” RCP between 3301 and 3302. 5/25/21 Tuesday Contractor (Clarkson - Gregg crew) installed 8’ of 24” RCP from 3301 to 3302, installed 25’ of 30” RCP, and 1 Flared End Section (FES ) From 1202 to 1203 and set lids on 1201 and 1202. 5/26/21 Wednesday Contractor (Clarkson - Gregg crew) poured collar and toe wall on 1203. 6/3/21 Thursday Contractor (Clarkson - Gregg Crew) installed 45’ of 24” HDPE Line 1300 and set Storm lid of 1301 may pour invert and collar for structure Monday 6/7/21. 6/17/21 Thursday Contractor (Clarkson - 2nd Crew) installed storm line 900 from structure 902 to 904 and began to install pipe to connect to Line 2000 out CI 903. Collars and inverts were done today. See PRSUB20202246 additional info. Contractor completed the installation of 12” HPDE on Line 2000 from 900 to Neo Plast structure. 6/22/21 Tuesday Contractor ( Clarkson - Darron Crew) installed Headwall (prefabricated) on storm line 1200 6/21/21. Collar for line 1200 on pipe and headwall should be poured today. 8/3/21 Tuesday On Thursday 7/29/21 Nyloplast 2204 A & B were installed. Contractor installed Nyloplast 2205 A & B, 2201 A & B and approximately 173’ of 15” corrugated storm pipe 8/2/21. Nyloplast 2202 A & B, 1901 A & B was installed today . Continued installation of storm pipe on line 1700, Nyloplast 1701 was set with approximately 50’ of 15” storm pipe. 8/4/21 Wednesday Contractor completed storm line 1700 was complete. 8/5/21 Thursday (Monday & Tuesday) Yesterday we set CI-501A, ran storm line 3800, poured collars & inverts in all of 400 line then collars & inverts in 501A & 3801. Wednesday 1702, 1702A & 1703, poured 5 yards concrete for collars & inverts in GI 1404 & 1901. Continued construction of storm lines. 8/11/21 Wednesday Monday 8/9/21: Installed Nyloplast 1401 with approximately 42’ of 18” HDPE, Rip Rap below storm line 600 & installed 336’ of 4” edge drain from Sta. 10+80.45 to inlet 602 on River Road. Tuesday 8/10/21: Contractor poured 4 yards concrete for collars on 1401 & 1701, toe walls on 600 & 1600 End Sections. Installed 629’ of 4” edge drain from inlet 602 to inlet 3302 on River Road. Contractor continued to work on storm line.
Piers/Caissons Inspection - Commercial Partial 4/26/2022 04/26/2022
Misc
Informational
04/26/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM
Piers/Caissons Inspection - Commercial Partial 6/27/2022 6/27/2022 06/27/2022
Misc
Informational
04/26/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM 6/27/22 - (4) light poles bases with ground rod at SW lot, west side at river rd
Piers/Caissons Inspection - Commercial Partial 6/29/2022 (9:00) 6/29/2022 06/29/2022
Misc
Informational
06/27/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM 6/27/22 - (4) light poles bases with ground rod at SW lot, west side at river rd 6/29/22- (5) bases with ground rods, SW lot
Piers/Caissons Inspection - Commercial Partial 6/30/2022 06/30/2022
Misc
Informational
06/29/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM 6/27/22 - (4) light poles bases with ground rod at SW lot, west side at river rd 6/29/22- (5) bases with ground rods, SW lot 6/30/22- (2) bases with ground rods, SW lot
Piers/Caissons Inspection - Commercial Partial 7/1/2022 7/1/2022 07/01/2022
Misc
Informational
06/30/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM 6/27/22 - (4) light poles bases with ground rod at SW lot, west side at river rd 6/29/22- (5) bases with ground rods, SW lot 6/30/22- (2) bases with ground rods, SW lot 7/1/22 - 1 base with ground rod, SW lot
Piers/Caissons Inspection - Commercial Partial 7/11/2022 07/11/2022
Misc
Informational
07/01/2022
POUR AT OWN RISK NO CITY STAMPED PLANS ON SITE (4) LIGHT POLE BASES (3) RIVER ROAD PARKING LOT EAST SIDE (1) 1 NEAR ROUNDABOUT IN ISLANDS : NOTE 2 POLE BASES ALREADY POURED AT EAST RIVER ROAD PARKING LOT. INSPECTED?? ON WHAT PERMIT ?? Michael Harkins 04/26/2022 3:51 PM 6/27/22 - (4) light poles bases with ground rod at SW lot, west side at river rd 6/29/22- (5) bases with ground rods, SW lot 6/30/22- (2) bases with ground rods, SW lot 7/1/22 - 1 base with ground rod, SW lot 7/11/22- (8) 1 base with ground rod, SW lot
Piers/Caissons Inspection - Commercial Passed 7/14/2022 7/14/2022 07/14/2022
Misc
Informational
07/11/2022
33 Piers with ground rods at NW and SW lots
Underground Electrical Inspection - Commercial Passed 7/14/2022 07/14/2022
Misc
Informational
07/14/2022
Conduit for light poles at SW lot west islands
Underground Electrical Inspection - Commercial Partial 9/12/2022 9/12/2022 09/12/2022
Misc
Informational
09/12/2022
09/12/22 Monday JMJ ( Westhues Electric ) 9 Underground conduit were installed 5 - 2” gray lines & 4 - 4” black lines ( Electrical ) .
Water Line - Construction Inspection Partial 9/27/2022 9/27/2022 09/28/2022
Misc
Informational
09/28/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main
Water Line - Construction Inspection Partial 09/29/2022
Misc
Informational
09/28/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main 9-29-22 AN. Still laying water main. ( informed contractor that they are not using the correct fire hydrants and they will correct.. need yellow and silver bonnet
Water Line - Construction Inspection Partial 09/30/2022
Misc
Informational
09/29/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main 9-29-22 AN. Still laying water main. ( informed contractor that they are not using the correct fire hydrants and they will correct.. need yellow and silver bonnet 9-30-22 AN. Water main still being installed. It is A line but not sure of station to station because contractor had revised plans that were not submitted to the city.
Water Line - Construction Inspection Partial 10/03/2022
Misc
Informational
09/30/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main 9-29-22 AN. Still laying water main. ( informed contractor that they are not using the correct fire hydrants and they will correct.. need yellow and silver bonnet 9-30-22 AN. Water main still being installed. It is A line but not sure of station to station because contractor had revised plans that were not submitted to the city. 10-3-22 AN. Still working on main - also waiting on the new plans to confirm locations.
Underground Electrical Inspection - Commercial Partial 10/4/2022 10/4/2022 10/04/2022
Misc
Informational
09/12/2022
09/12/22 Monday JMJ ( Westhues Electric ) 9 Underground conduit were installed 5 - 2” gray lines & 4 - 4” black lines ( Electrical ) - 10/4/22 SE FIELD # 2 UNDERGROUND CONDUIT FROM MIDDLE FIELD 1&2 TO MIDDLE FIELD 2&3 -
Water Line - Construction Inspection Partial 10/05/2022
Misc
Informational
10/03/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main 9-29-22 AN. Still laying water main. ( informed contractor that they are not using the correct fire hydrants and they will correct.. need yellow and silver bonnet 9-30-22 AN. Water main still being installed. It is A line but not sure of station to station because contractor had revised plans that were not submitted to the city. 10-3-22 AN. Still working on main - also waiting on the new plans to confirm locations. 10/05/22 Wednesday JMJ ( Pro Design ) Contractor installed approximately 160’ of 4” PVC, 100’ of 1.5’ Copper, & 100’ of 2” Copper for concession stand. Contractor began excavating 6” water. Boring will be required because of the already installed pavement parking entrance.
Water Line - Construction Inspection Partial 10/06/2022
Misc
Informational
10/05/2022
9-26-22 AN. Began to install private water main 9-27-22 AN. Continuing to install water main 9-28-22 AN. Continuing to install water main 9-29-22 AN. Still laying water main. ( informed contractor that they are not using the correct fire hydrants and they will correct.. need yellow and silver bonnet 9-30-22 AN. Water main still being installed. It is A line but not sure of station to station because contractor had revised plans that were not submitted to the city. 10-3-22 AN. Still working on main - also waiting on the new plans to confirm locations. 10/05/22 Wednesday JMJ ( Pro Design Construction ) Contractor excavating for installation of complex water Line A. 10/06/22 Thursday JMJ ( Pro Design Construction ) Contractor installed water meter Backflow vault. I advise contractor to get a third party inspector to inspect installation of meter and Backflow preventer.
Water Line - Construction Inspection Partial 10/07/2022
Misc
Informational
10/07/2022
10/07/22 Friday JMJ ( Pro Design Const/ Miller Excavation Inc. ) Contractor bored approximately 80’ of 6” PVC water pipe. Contractor continues to install water line. A 6”X6” Tee was installed and additional stick of 6” water pipe. Contractor installed approximately 120’ of 6” PVC water yesterday that was connected with the stick of pipe that was installed after the 6”X6” Tee. A Hydrant will be installed off that Tee as per project plans.
Piers/Caissons Inspection - Commercial Partial 10/10/2022 (9:00) 10/10/2022 10/10/2022
Misc
Informational
10/10/2022
10/10/22 # S4 BETWEEN FIELDS 1 & 2 42" DIA, 23' DEPTH, 18 # 7 BARS VERTICAL W/ #4 HORIZONTAL TIES @ 12" - - 10/10/22 S1 FIELD 1 AT BLEACHERS 42" DIA 21' DEPTH 18 # 7 BARS VERTICAL W/ #4 BARS HORIZONTAL TIES, S14 BETWEEN FIELDS 5 & 6 42" DIA 23' DEPTH 18 # 7 BARS W/ # 4 HORIZONTAL BARS @ 12" - : ALSO CALLED IN ON PERMIT # 20223181 :
Water Line - Construction Inspection Partial 10/10/2022
Misc
Informational
10/07/2022
10/07/22 Friday JMJ ( Pro Design Const/ Miller Excavation Inc. ) Contractor bored approximately 80’ of 6” PVC water pipe. Contractor continues to install water line. 10/10/22 Monday JMJ ( Pro Design Const. ) Contractor continued installation of Backflow and By-Pass valves, vault, and meter. Fire hydrant was install with hydrant valve approximately 8’ off 6” water main.
Sanitary Sewer Construction Inspection Partial 10/11/2022
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ ( Pro Developer ) Approximately 80’ of 6” SDR Sanitary sewer pipe on the private side that connects to the concession stand. The contractor showed of the backfilling of the pipe.
Roof Drain Partial 10/11/2022
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ ( Pro Developer ) Contractor installed 10’ of 6” HDPE corrugated storm drain pipe.
Sanitary Sewer Construction Inspection Partial 10/11/2022
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ ( Pro Developer ) Approximately 80’ of 6” SDR Sanitary sewer pipe on the private side that connects to the concession stand. The contractor showed of the backfilling of the pipe. Clean-out pipe was also installed on the line.
Fire Line - Hydrostatic Test Partial 10/12/2022
Misc
Informational
10/12/2022
10/12/22 Wednesday JMJ ( Pro Design ) Fire Line hydrostatic test passed from 3:00 PM to 5:00 PM @ 200psi.
Underground Electrical Inspection - Commercial Partial 1/13/2023 1/13/2023 01/13/2023
Misc
Informational
10/04/2022
09/12/22 Monday JMJ ( Westhues Electric ) 9 Underground conduit were installed 5 - 2” gray lines & 4 - 4” black lines ( Electrical ) - 10/4/22 SE FIELD # 2 UNDERGROUND CONDUIT FROM MIDDLE FIELD 1&2 TO MIDDLE FIELD 2&3 - 1/13/23 -4" Conduit for concession stand from SE corner of field 6 to center of field 6
Underground Electrical Inspection - Commercial Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/13/2023
09/12/22 Monday JMJ ( Westhues Electric ) 9 Underground conduit were installed 5 - 2” gray lines & 4 - 4” black lines ( Electrical ) - 10/4/22 SE FIELD # 2 UNDERGROUND CONDUIT FROM MIDDLE FIELD 1&2 TO MIDDLE FIELD 2&3 - 1/13/23 -4" Conduit for concession stand from SE corner of field 6 to center of field 6 1/17/23 -Conduit from center of 6 to SE corner of field 2
Final Electrical Inspection - Commercial Failed 1/24/2023 1/24/2023 01/24/2023
Misc
Corrective Action Required
01/24/2023
Provide updated one line drawing for service
Final Electrical Inspection - Commercial Failed 2/9/2023 2/9/2023 02/09/2023
Misc
Corrective Action Required
01/24/2023
-Provide second ground rod and GEC per revised detail -Provide permanent label at service "ELECTRICAL SERVICE #2" per detail -Unable to perform electrical service on a site permit
Site Visit Partial 4/11/2023 4/11/2023 04/11/2023
Misc
Informational
03/01/2021
Storm Sewer was delivered to site and excavation was continued.
Misc
Informational
04/11/2023
04/11/23 Tuesday JMJ ( Precision Construction - Blake ) Contractor has been working on private utilities water, sanitary & storm. Contractor notified inspector last week of work, it was discovered by the inspector that the plans were not approved for the new additions of water and sanitary. Plans were submitted and approved by Friday of last week. Contractor took pictures of water and sanitary and emailed pictures to inspector for documentation. Today and yesterday contractor worked on installation of soccer field draining system as per plans.
Water Line - Hydrostatic Test Passed 4/12/2023 4/12/2023 04/12/2023
Misc
Informational
04/12/2023
04/12/23 Wednesday JMJ ( Percision Construction ) Contractor pass the 2hr hydrostatic test at 150psi.
Water Line - Construction Inspection Partial 4/12/2023 4/12/2023 04/12/2023
Misc
Informational
10/10/2022
10/07/22 Friday JMJ ( Pro Design Const/ Miller Excavation Inc. ) Contractor bored approximately 80’ of 6” PVC water pipe. Contractor continues to install water line. 10/10/22 Monday JMJ ( Pro Design Const. ) Contractor continued installation of Backflow and By-Pass valves, vault, and meter. Fire hydrant was install with hydrant valve approximately 8’ off 6” water main.
Misc
Informational
04/12/2023
04/12/23 Wednesday JMJ ( Percision Construction ) Contractor plan to chlorinate lines around soccer field and behind the bleachers. ( The company is correctly name Pro Design Construction. ) Chlorination of lines were completed.
Water Line - Construction Inspection Partial 4/14/2023 4/14/2023 04/14/2023
Misc
Informational
04/12/2023
10/07/22 Friday JMJ ( Pro Design Const/ Miller Excavation Inc. ) Contractor bored approximately 80’ of 6” PVC water pipe. Contractor continues to install water line. 10/10/22 Monday JMJ ( Pro Design Const. ) Contractor continued installation of Backflow and By-Pass valves, vault, and meter. Fire hydrant was install with hydrant valve approximately 8’ off 6” water main.
Misc
Informational
04/12/2023
04/12/23 Wednesday JMJ ( Pro Design Construction ) Contractor chlorinated water line that runs behind bleacher stands on 04/12/23. 04/14/23 Thursday JMJ ( pro Design Construction ) Contractor dechlorinated water line started at 7:00AM.
Water Line - Coliform Test 1 Passed 4/19/2023 4/19/2023 04/19/2023
Misc
Informational
04/19/2023
04/19/23 Wednesday JMJ ( Pro Design Inc. ) The first bacteria test passed.
Water Line - Coliform Test 2 Passed 4/20/2023 4/20/2023 04/20/2023
Misc
Informational
04/20/2023
04/20/23 Thursday JMJ ( Pro Design Inc. ) Second bacteria sample passed. See documents for consecutive passing samples.
Install Street and Stop Signs Passed 05/12/2023
Sanitary Sewer Construction Inspection Passed 05/12/2023
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ ( Pro Developer ) Approximately 80’ of 6” SDR Sanitary of the pipe. Clean-out pipe was also installed on the line.
Water Line - Construction Inspection Passed 05/12/2023
Misc
Informational
04/14/2023
10/07/22 Friday JMJ ( Pro Design Const/ Miller Excavation Inc. ) Contractor bored approximately 80’ of 6” PVC water pipe. Contractor continues to install water line. 10/10/22 Monday JMJ ( Pro Design Const. ) Contractor continued installation of Backflow and By-Pass valves, vault, and meter. Fire hydrant was install with hydrant valve approximately 8’ off 6” water main.
Misc
Informational
04/14/2023
04/12/23 Wednesday JMJ ( Pro Design Construction ) Contractor chlorinated water line that runs behind bleacher stands on 04/12/23. 04/14/23 Thursday JMJ ( pro Design Construction ) Contractor dechlorinated water line started at 7:00AM.
Final Completion - Field Engineering Final Completion 11/06/2024
Documents & Images
Date Uploaded File Type Document Name
08/03/2020 Receipt Receipt for transaction:2020-004917
08/05/2020 Approved Plans approved PS Soccer Complex Field Storm Sewer Plans 8_5_20
08/05/2020 Letter DE-Permit
10/20/2020 Approved Plans Paragon Star Soccer Complex Field Storm Sewer Approved 10.20.20
01/18/2021 image.jpg
01/18/2021 image.jpg0
01/18/2021 Letter INSPECTION SUMMARY
01/19/2021 image.jpg1
01/19/2021 image.jpg2
01/19/2021 image.jpg3
01/19/2021 image.jpg4
01/19/2021 image.jpg5
01/19/2021 image.jpg6
01/19/2021 Letter INSPECTION SUMMARY
01/19/2021 Letter INSPECTION SUMMARY
01/19/2021 Letter INSPECTION SUMMARY
01/20/2021 image.jpg7
01/20/2021 image.jpg8
01/20/2021 image.jpg9
01/20/2021 image.jpg10
01/20/2021 Letter INSPECTION SUMMARY
01/21/2021 image.jpg11
01/21/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
02/03/2021 image.jpg12
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/05/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/24/2021 Letter INSPECTION SUMMARY
02/25/2021 Letter INSPECTION SUMMARY
02/25/2021 Letter INSPECTION SUMMARY
03/01/2021 Letter INSPECTION SUMMARY
03/08/2021 Letter INSPECTION SUMMARY
04/19/2021 Letter INSPECTION SUMMARY
04/19/2021 Letter INSPECTION SUMMARY
06/17/2021 image.jpg13
04/13/2022 Receipt Receipt for transaction: 2022-002041
04/26/2022 Approved Plans Approved Soccer Field Plans Civil Only 2020_11_04_PL2019407_Part1
04/26/2022 Approved Plans Building plans for parking E100
04/26/2022 Email Light Pole Foundation_Version_1
04/26/2022 Letter INSPECTION SUMMARY
06/27/2022 Letter INSPECTION SUMMARY
06/29/2022 Letter INSPECTION SUMMARY
06/30/2022 Letter INSPECTION SUMMARY
07/01/2022 Letter INSPECTION SUMMARY
07/11/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY
07/14/2022 Letter INSPECTION SUMMARY

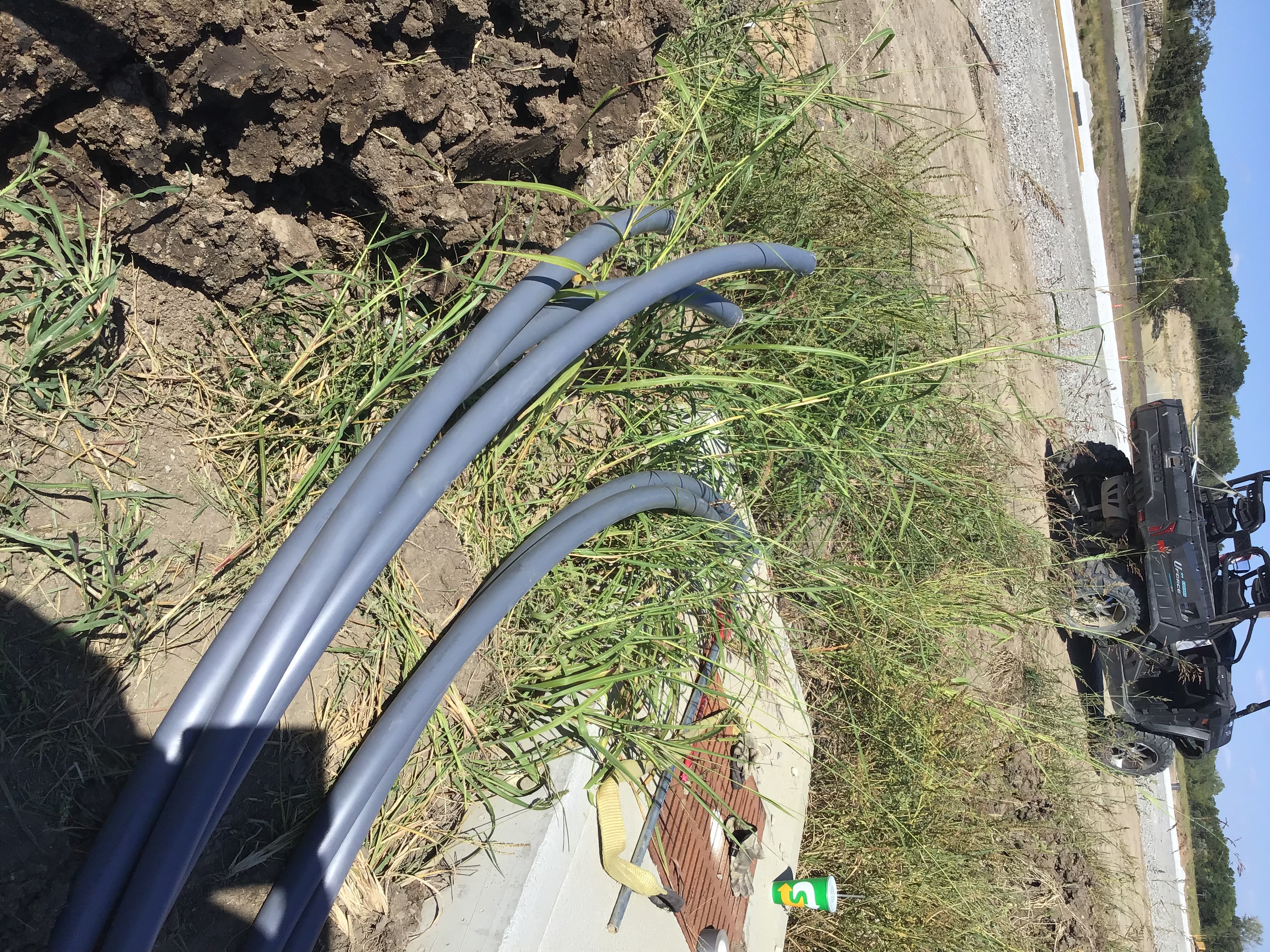

09/12/2022 Gray Conduit
09/12/2022 Black Conduit
09/12/2022 Letter INSPECTION SUMMARY
09/28/2022 Letter INSPECTION SUMMARY
09/29/2022 Letter INSPECTION SUMMARY
09/30/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/04/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY

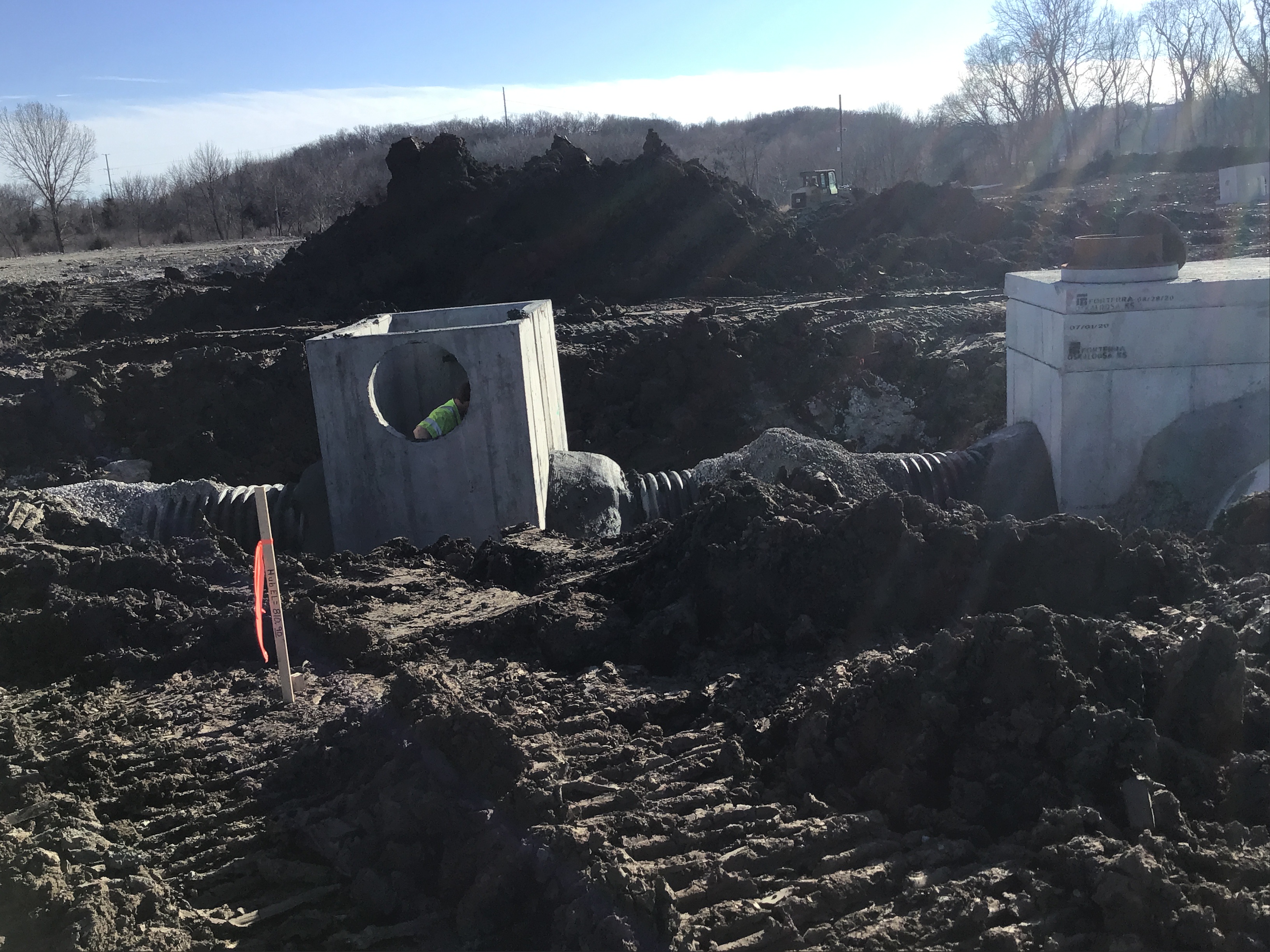

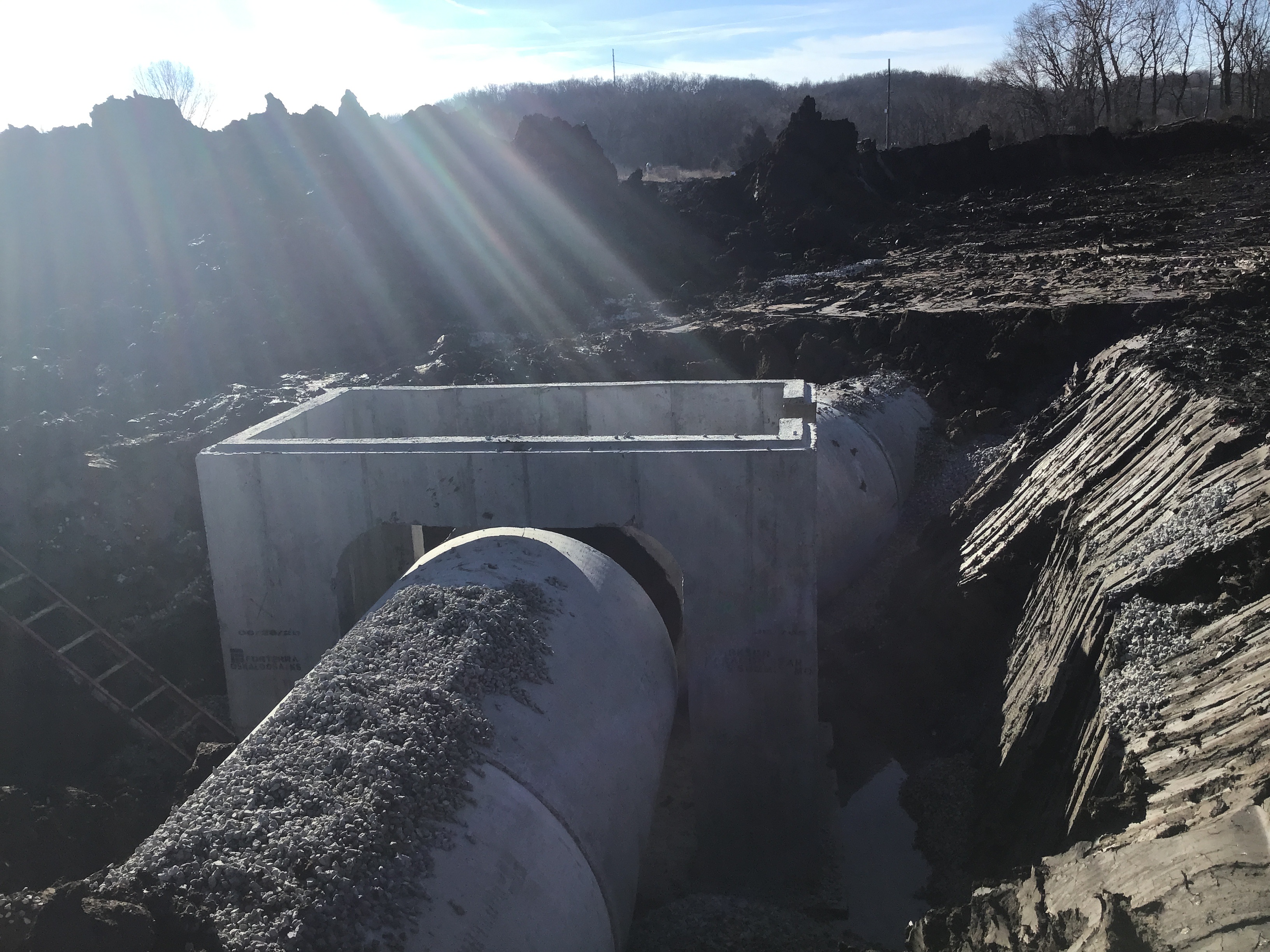

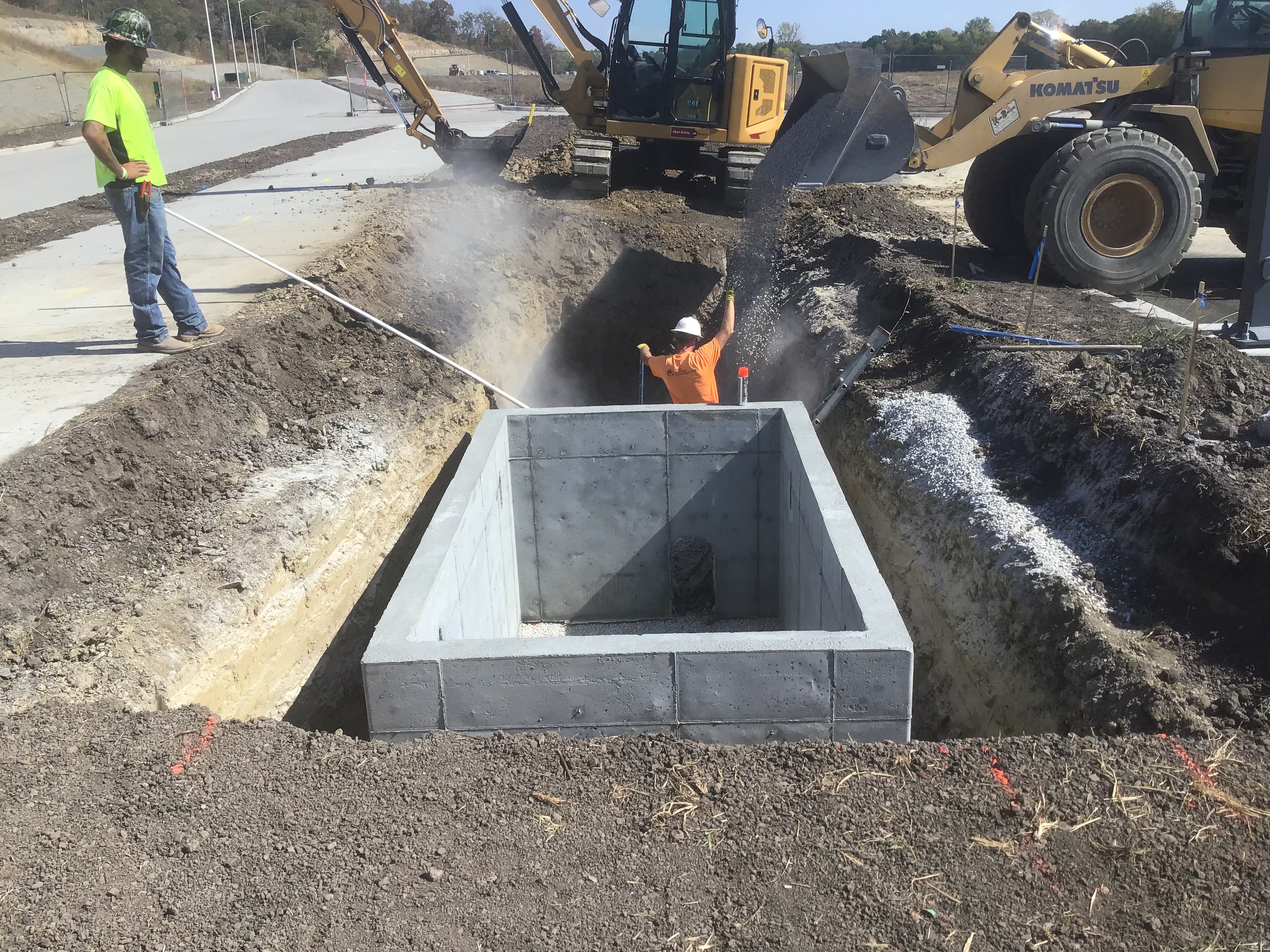

10/06/2022 Vault
10/06/2022 Letter INSPECTION SUMMARY
10/06/2022 Letter INSPECTION SUMMARY
10/07/2022 Letter INSPECTION SUMMARY
10/07/2022 Application Form Approved - MUSCO Pole Foundations
10/10/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY

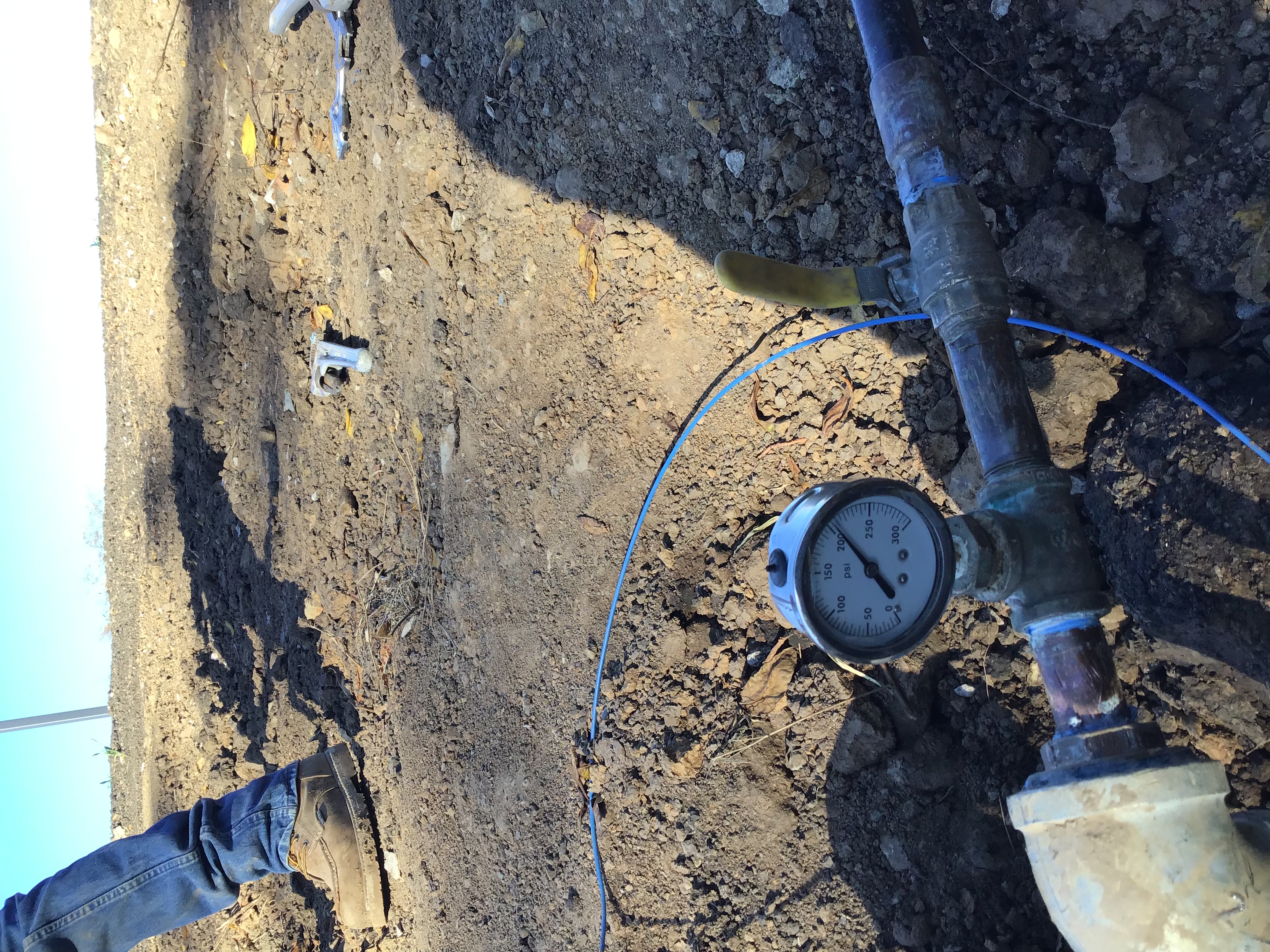

10/12/2022 Gauge 200 psi for Hydrostatic Test
10/12/2022 Letter INSPECTION SUMMARY
10/12/2022 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
02/03/2023 Approved Plans approved - E301 - Oneline Diagram BP1
02/09/2023 Electrical service 2 location
02/09/2023 Electrical service #2 location
02/09/2023 Letter INSPECTION SUMMARY
02/14/2023 Approved Plans approved - E301 - Oneline Diagram BP1
04/07/2023 Approved Plans APPROVED PS SOCCER COMPLEX SHEETS C401 409 AND 505
04/11/2023 Letter INSPECTION SUMMARY
04/12/2023 Letter INSPECTION SUMMARY
04/12/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter INSPECTION SUMMARY
04/14/2023 Letter INSPECTION SUMMARY
04/19/2023 Email Work Order 1GD1629 - City of Lees Summit - Paragon Star First Passing Test for Soccer Field
04/20/2023 Email Work Order 1GD1706 - City of Lees Summit - Paragon Star Second Sample Soccer Field Private Water Line
04/20/2023 Letter INSPECTION SUMMARY
04/20/2023 Letter INSPECTION SUMMARY
05/24/2023 Letter DE-Certificate of Substantial Completion Single Lot
08/03/2023 Letter DE-Certificate of Substantial Completion Single Lot
08/03/2023 Letter DE-Punch List
11/06/2024 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
