Summary
PRRES20233664
Building Permit - Residential
Certificate of Occupancy
SAB CONSTRUCTION LLC
NEW SINGLE FAMILY
NEW HOUSE. WALKOUT/WALKUP BASEMENT. FINISHED/UNFINISHED BASEMENT. COVERED DECK. STOP WORK ORDER generated on 10/11/2023 12:00 AM by username 'Mitchell Schwarz'. STOP WORK ORDER removed on 10/19/2023 12:00 AM by username 'Mitchell Schwarz'.
07/27/2023
08/04/2023
01/28/2024
07/24/2024
Locations
Contacts
SAB CONSTRUCTION INC, Address:PO BOX 942, Phone:(816) 524-3855
SAB CONSTRUCTION LLC, Address:200 NW COMMERCE CT
Joseph Matthew Schartz, Address:PO Box 942, Phone:(816) 524-3855
MIKE BRYANT HEATING & COOLING , Address:1711 E 123RD , Phone:(913) 441-7807
TEAGUE ELECTRIC CONSTRUCTION INC, Address:12425 W 92ND ST, Phone:(913) 529-4600
GARRISON PLUMBING, Address:15430 S MAHAFFIE ST STE 102, Phone:(913) 768-1311
TALBY@SABHOMES.COM
Reviews

There are no reviews for this permit application.

Fees
Paid Fees Amount Paid Owing Date Paid
8331401-Water Tap Fee $3,760.00 $3,760.00 Paid 08/04/2023
8350015-Water Meter Fee $680.46 $680.46 Paid 08/04/2023
8331507-Sanitary Sewer Development Fee $2,159.00 $2,159.00 Paid 08/04/2023
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 08/04/2023
7232302-Residential License Tax Fee $1,022.72 $1,022.72 Paid 08/04/2023
9110078-Valuation Fee New Single Family $1,713.35 $1,713.35 Paid 08/04/2023
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Footing Inspection - Residential Passed 8/16/2023 (11:15) 8/17/2023 08/17/2023
Misc
Resolved
08/17/2023
- Footing is supposed to have had a third party inspection. 8/16/23 AF
Misc
Informational
08/17/2023
Passed per third party
Underslab Plumbing Inspection - Residential Passed 8/30/2023 8/30/2023 08/30/2023
All Rough Inspection - Residential Failed 9/27/2023 9/27/2023 09/27/2023
Misc
Corrective Action Required
09/27/2023

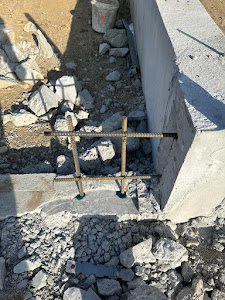

No inspection performed Provide engineering for damaged foundation wall at garage.
Sewer Service Inspection - R Passed 9/29/2023 (3:30) 9/29/2023 09/29/2023
Water Service Inspection - R Passed 10/3/2023 10/03/2023
All Rough Inspection - Residential Failed - Stop Work 10/11/2023 10/11/2023
Misc
Corrective Action Required
09/27/2023
No inspection performed Provide engineering for damaged foundation wall at garage. Stop work issued -engineer letter needs to provide details on fix for foundation wall repair. Repair made and concrete poured without inspection.
All Rough Inspection - Residential Partial 10/19/2023 10/19/2023
Misc
Resolved
10/19/2023
No inspection performed Provide engineering for damaged foundation wall at garage. Stop work issued -engineer letter needs to provide details on fix for foundation wall repair. Repair made and concrete poured without inspection.
All Rough Inspection - Residential Failed 12/22/2023 12/22/2023 12/22/2023
Misc
Informational
12/22/2023
-Garage portal frame inspection only.
Erosion Control Inspection Residential Failed 12/22/2023 12/22/2023
DCM1 ESC REQUIRED NO FURTHER INSP
Corrective Action Required
12/22/2023
EROSION CONTROL REQUIRED. NO FURTHER INSPECTIONS WILL BE PERFORMED UNTIL EROSION CONTROL IS INSTALLED AND IN COMPLIANCE.
DCM3 ESC REQUIRED 2 DAY
Corrective Action Required
12/22/2023
EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. Clean trash from lot
All Rough Inspection - Residential Partial 1/3/2024 1/3/2024 01/03/2024
Misc
Informational
12/22/2023
-Garage portal frame inspection only. Okay to cover
All Rough Inspection - Residential Partial 1/11/2024 1/11/2024 01/11/2024
Misc
Informational
01/03/2024
-Garage portal frame and covered deck inspection only. Okay to cover
Erosion Control Inspection Residential Failed 2/6/2024 02/06/2024
DCM1 ESC REQUIRED NO FURTHER INSP
Resolved
02/06/2024
EROSION CONTROL REQUIRED. NO FURTHER INSPECTIONS WILL BE PERFORMED UNTIL EROSION CONTROL IS INSTALLED AND IN COMPLIANCE.
DCM3 ESC REQUIRED 2 DAY
Resolved
02/06/2024
EROSION CONTROL REQUIRED. EROSION CONTROL SHALL BE IN COMPLIANCE WITHIN TWO BUSINESS DAYS. Clean trash from lot
DCM2 ESC DEFICIENT INSTALLATION
Corrective Action Required
02/06/2024
DEFICIENT EROSION CONTROL INSTALLATION. NO FURTHER INSPECTIONS UNTIL ADEQUATE EROSION CONTROL PROVIDED. Maintain silt fence Maintain lot access Clean trash and debris from lot
Electrical Service Inspection Failed 3/8/2024 03/08/2024
Miscellaneous Correction
Corrective Action Required
03/08/2024
Grounding for gas line in electrical panel is loose and pulled out
Gas Service Inspection - Residential Failed 3/8/2024 03/08/2024
Miscellaneous Correction
Corrective Action Required
03/08/2024
Grounding at electrical panel is not installed
All Rough Inspection - Residential Failed 3/7/2024 3/8/2024 03/08/2024
Misc
Informational
01/11/2024
-Garage portal frame and covered deck inspection only. Okay to cover
Miscellaneous Correction
Corrective Action Required
03/08/2024
2206 SW Red Barn. All rough -Wall studs in garage south side do not bear on the sole plate -Wall studs in garage south side do not have full bearing width on sole plate -Wall studs in garage has a 2x6 cut out and installed a horizontal 2x6 which has more than a 1/4 gap at studs to 2x6 -Some anchor bolts in garage sole plate are not located in the middle 1/3 -Ridge beam rafters throughout can not be off set more than 1 3/4 inches from the opposite side -Front door assembly from sole plate to top plate does not have king studs, only jack studs -Bedroom 2 has a bottom plate cut out where is supports a vertical load to the roof -Have engineer address rafters in bedroom 2 going from a non continuous 2x8 to a 2x8 ridge to a 2x6 ridge. -Fill in over cut Fire blocking for plumbing lines at kitchen cabinets to master suite above ceiling height -Have engineers letter of approval for over cut hip beam in master bedroom and install vertical bracing for the hip beam for load transfer -Corner in master suite has been cut to piece in porch beam -Fire block HVAC supply line in master suite shower to closet at top plate -Replace broken out Fire blocking in master closet at electrical lines -Master closet HVAC supply line is blocked by 2x4 fire blocking -Fire place is not installed and gas line is not hooked up -Kitchen ceiling beam transfer load on the S/E side needs one more stud added for a total of a five pack to match the top -Dining room corners need to be nailed off 12 inches on center -Fire block bedroom 4 at furr down to vertical studs at both ends -Seal (fire block) gap at plumbing waste line in bedroom 4 above window -Seal (fire block) gap at plumbing waste line in bedroom 3’s closet -Multi anchor bolts in basement need to be located in the middle 1/3 of sole plate -Anchor bolt nuts in window seal of bedroom 3 are not installed -All through bolts are not installed on back deck beam to post connections -One floor joist is missing nails on the back deck -Bonding line to gas pipe in electrical panel was loose and pulled out -Rafter purlin above master closet to full bath and bedroom 2 closet is not installed
All Rough Inspection - Residential Failed 3/19/2024 3/19/2024 03/19/2024
Misc
Informational
03/08/2024
-Garage portal frame and covered deck inspection only. Okay to cover
Miscellaneous Correction
Corrective Action Required
03/08/2024
2206 SW Red Barn. All rough -Wall studs in garage south side do not bear on the sole plate -Wall studs in garage south side do not have full bearing width on sole plate -Wall studs in garage has a 2x6 cut out and installed a horizontal 2x6 which has more than a 1/4 gap at studs to 2x6 -Some anchor bolts in garage sole plate are not located in the middle 1/3 -Ridge beam rafters throughout can not be off set more than 1 3/4 inches from the opposite side -Front door assembly from sole plate to top plate does not have king studs, only jack studs -Bedroom 2 has a bottom plate cut out where is supports a vertical load to the roof -Have engineer address rafters in bedroom 2 going from a non continuous 2x8 to a 2x8 ridge to a 2x6 ridge. -Fill in over cut Fire blocking for plumbing lines at kitchen cabinets to master suite above ceiling height -Have engineers letter of approval for over cut hip beam in master bedroom and install vertical bracing for the hip beam for load transfer -Corner in master suite has been cut to piece in porch beam -Fire block HVAC supply line in master suite shower to closet at top plate -Replace broken out Fire blocking in master closet at electrical lines -Master closet HVAC supply line is blocked by 2x4 fire blocking -Fire place is not installed and gas line is not hooked up -Kitchen ceiling beam transfer load on the S/E side needs one more stud added for a total of a five pack to match the top -Dining room corners need to be nailed off 12 inches on center -Fire block bedroom 4 at furr down to vertical studs at both ends -Seal (fire block) gap at plumbing waste line in bedroom 4 above window -Seal (fire block) gap at plumbing waste line in bedroom 3’s closet -Multi anchor bolts in basement need to be located in the middle 1/3 of sole plate -Anchor bolt nuts in window seal of bedroom 3 are not installed -All through bolts are not installed on back deck beam to post connections -One floor joist is missing nails on the back deck -Bonding line to gas pipe in electrical panel was loose and pulled out -Rafter purlin above master closet to full bath and bedroom 2 closet is not installed
Miscellaneous Correction
Corrective Action Required
03/19/2024
2206 SW Red Barn. All rough (2) •Wall studs in garage south side do not bear on the sole plate •Wall studs in garage south side do not have full bearing width on sole plate •Some anchor bolts in garage sole plate are not located in the middle 1/3 •Ridge beam rafters throughout can not be off set more than 1 3/4 inches from the opposite side •Have engineer address rafters in bedroom 2 going from a non continuous 2x8 to a 2x8 ridge to a 2x6 ridge. •Fill in over cut Fire blocking for plumbing lines at kitchen cabinets to master suite above ceiling height •Vertically support both LVL’s above master bedroom with purlins •Corner in master suite has been cut to piece in porch beam •Master closet HVAC supply line is blocked by 2x4 fire blocking •Dining room corners need to be nailed off 12 inches on center •Seal (fire block) gap at plumbing waste line in bedroom 4 above window •Multi anchor bolts in basement need to be located in the middle 1/3 of sole plate •Anchor bolt nuts in window seal of bedroom 3 are not installed •All through bolts are not installed on back deck beam to post connections •One floor joist is missing nails on the back deck
All Rough Inspection - Residential Passed 3/27/2024 3/27/2024 03/27/2024
Misc
Informational
03/19/2024
-Garage portal frame and covered deck inspection only. Okay to cover
Miscellaneous Correction
Corrective Action Required
03/19/2024
2206 SW Red Barn. All rough -Wall studs in garage south side do not bear on the sole plate -Wall studs in garage south side do not have full bearing width on sole plate -Wall studs in garage has a 2x6 cut out and installed a horizontal 2x6 which has more than a 1/4 gap at studs to 2x6 -Some anchor bolts in garage sole plate are not located in the middle 1/3 -Ridge beam rafters throughout can not be off set more than 1 3/4 inches from the opposite side -Front door assembly from sole plate to top plate does not have king studs, only jack studs -Bedroom 2 has a bottom plate cut out where is supports a vertical load to the roof -Have engineer address rafters in bedroom 2 going from a non continuous 2x8 to a 2x8 ridge to a 2x6 ridge. -Fill in over cut Fire blocking for plumbing lines at kitchen cabinets to master suite above ceiling height -Have engineers letter of approval for over cut hip beam in master bedroom and install vertical bracing for the hip beam for load transfer -Corner in master suite has been cut to piece in porch beam -Fire block HVAC supply line in master suite shower to closet at top plate -Replace broken out Fire blocking in master closet at electrical lines -Master closet HVAC supply line is blocked by 2x4 fire blocking -Fire place is not installed and gas line is not hooked up -Kitchen ceiling beam transfer load on the S/E side needs one more stud added for a total of a five pack to match the top -Dining room corners need to be nailed off 12 inches on center -Fire block bedroom 4 at furr down to vertical studs at both ends -Seal (fire block) gap at plumbing waste line in bedroom 4 above window -Seal (fire block) gap at plumbing waste line in bedroom 3’s closet -Multi anchor bolts in basement need to be located in the middle 1/3 of sole plate -Anchor bolt nuts in window seal of bedroom 3 are not installed -All through bolts are not installed on back deck beam to post connections -One floor joist is missing nails on the back deck -Bonding line to gas pipe in electrical panel was loose and pulled out -Rafter purlin above master closet to full bath and bedroom 2 closet is not installed
Miscellaneous Correction
Corrective Action Required
03/19/2024
2206 SW Red Barn. All rough (2) •Wall studs in garage south side do not bear on the sole plate •Wall studs in garage south side do not have full bearing width on sole plate •Some anchor bolts in garage sole plate are not located in the middle 1/3 •Ridge beam rafters throughout can not be off set more than 1 3/4 inches from the opposite side •Have engineer address rafters in bedroom 2 going from a non continuous 2x8 to a 2x8 ridge to a 2x6 ridge. •Fill in over cut Fire blocking for plumbing lines at kitchen cabinets to master suite above ceiling height •Vertically support both LVL’s above master bedroom with purlins •Corner in master suite has been cut to piece in porch beam •Master closet HVAC supply line is blocked by 2x4 fire blocking •Dining room corners need to be nailed off 12 inches on center •Seal (fire block) gap at plumbing waste line in bedroom 4 above window •Multi anchor bolts in basement need to be located in the middle 1/3 of sole plate •Anchor bolt nuts in window seal of bedroom 3 are not installed •All through bolts are not installed on back deck beam to post connections •One floor joist is missing nails on the back deck
Electrical Service Inspection Passed 4/5/2024 4/4/2024 04/04/2024
Miscellaneous Correction
Resolved
04/04/2024
Grounding for gas line in electrical panel is loose and pulled out
Gas Service Inspection - Residential Passed 4/5/2024 4/4/2024 04/04/2024
Miscellaneous Correction
Resolved
04/04/2024
Grounding at electrical panel is not installed
Sidewalk Inspection Partial 5/10/2024 5/10/2024 05/23/2024
Misc
Informational
05/10/2024
5-23-24 Dustin A, SW has not been poured yet. will need pre pour inspection called in
Driveway Inspection Partial 5/10/2024 5/10/2024 05/23/2024
Misc
Informational
05/10/2024
5-23-24 Dustin A, DW has not been poured yet. will need pre pour inspection called in
Driveway Inspection Partial 5/30/2024 5/30/2024 05/29/2024
Misc
Informational
05/23/2024
5-23-24 Dustin A, SW has not been poured yet. will need pre pour inspection called in
Sidewalk Inspection Partial 5/30/2024 5/30/2024 05/29/2024
Misc
Informational
05/29/2024
5-29-24 Dustin A, SW was not poured yet. Will need a pre pour called in
Driveway Inspection Partial 7/8/2024 7/8/2024 07/08/2024
Misc
Informational
05/29/2024
5-23-24 Dustin A, SW has not been poured yet. will need pre pour inspection called in 6-12-24 Dustin A, No work has been done. Will need to call in for a pre pour inspection 7-8-24 DP. DW was formed, Aggregate compacted, keep cross slopes in compliance. Approve to pour.
Sidewalk Inspection Partial 7/8/2024 7/8/2024 07/08/2024
Misc
Informational
05/29/2024
5-29-24 Dustin A, SW was not poured yet. Will need a pre pour called in 6-12-24 Dustin A, No work has been done since last visit. Will need to call in pre pour inspection in 7-8-24 DP. SW was formed, cross slopes were in compliance, aggregate compacted but conditions can change. Approved to pour.
Driveway Inspection Passed 7/16/2024 7/16/2024 07/16/2024
Misc
Informational
07/08/2024
5-23-24 Dustin A, SW has not been poured yet. will need pre pour inspection called in 6-12-24 Dustin A, No work has been done. Will need to call in for a pre pour inspection 7-8-24 DP. DW was formed, Aggregate compacted, keep cross slopes in compliance. Approve to pour. 7-16-24 Dustin A, DW was poured to city specs and slopes are in compliance. Passed
Sidewalk Inspection Passed 7/16/2024 7/16/2024 07/16/2024
Misc
Informational
07/08/2024
5-29-24 Dustin A, SW was not poured yet. Will need a pre pour called in 6-12-24 Dustin A, No work has been done since last visit. Will need to call in pre pour inspection in 7-8-24 DP. SW was formed, cross slopes were in compliance, aggregate compacted but conditions can change. Approved to pour. 7-16-24 Dustin A, SW was poured to city specs and slopes are in compliance. Passed
Occupancy Inspection - Codes Residential Failed 7/17/2024 07/17/2024
Misc
Corrective Action Required
07/17/2024
-Provide as graded plot plan -obtain issued lawn irrigation permit -afci protection for outlets as required by code. (Circuit 14) -handrail at deck stairs -handrail at patio stairs -spark rings at basement wet bar backsplash -deck post to beam connections -set screw installed and sheared off at water anti syphon device -all non GFCI outlets to be single receptacle and labeled (see sump pump) -will check water meter depth at time of re-inspection ensure 14”-18” from top of meter to well lid ring
Plot Plan Inspection Passed 7/24/2024 07/24/2024
Erosion Control Inspection Residential Passed 07/24/2024
DCM2 ESC DEFICIENT INSTALLATION
Resolved
07/24/2024
DEFICIENT EROSION CONTROL INSTALLATION. NO FURTHER INSPECTIONS UNTIL ADEQUATE EROSION CONTROL PROVIDED. Maintain silt fence Maintain lot access Clean trash and debris from lot
Occupancy Inspection - Codes Residential Full C of O 7/24/2024 7/24/2024 07/24/2024
Misc
Resolved
07/24/2024
-Provide as graded plot plan -obtain issued lawn irrigation permit -afci protection for outlets as required by code. (Circuit 14) -handrail at deck stairs -handrail at patio stairs -spark rings at basement wet bar backsplash -deck post to beam connections -set screw installed and sheared off at water anti syphon device -all non GFCI outlets to be single receptacle and labeled (see sump pump) -will check water meter depth at time of re-inspection ensure 14”-18” from top of meter to well lid ring
Documents & Images
Date Uploaded File Type Document Name
07/27/2023 HFR056 - Air Combustion Calculation
07/27/2023 HFR056 - Excise Tax Application
07/27/2023 HFR056 - Permit Application
08/01/2023 Approved Plans APPROVED PLANS
08/01/2023 Permit Codes Residential Plan Review
08/03/2023 Plot Plan APPROVED PLOT PLAN
08/03/2023 Permit Codes Residential Plan Review
08/04/2023 Permit DS Building Permit
08/04/2023 Receipt Receipt for transaction:2023-006048
08/16/2023 2206 SW Red Barn Ln LSMO Retreat at Hook Farms Lot 56 Footing Inspection Report 8-15-23
08/30/2023 Letter INSPECTION SUMMARY
08/30/2023 Letter INSPECTION SUMMARY
09/27/2023 Letter INSPECTION SUMMARY
09/29/2023 Letter INSPECTION SUMMARY
10/03/2023 Letter INSPECTION SUMMARY
10/04/2023 2206 SW Red Barn Ln LSMO Retreat at Hook Farms Lot 56 Damaged Concrete @ Garage Door Inspection Report 10-3-23
10/11/2023 Letter Stop Work Order
10/16/2023 2206 SW Red Barn Ln LSMO Retreat at Hook Farms Lot 56 Damaged Concrete @ Garage Door Inspection Report 10-16-23
10/19/2023 HFR056 2206 SW Red Barn Ln Repair per Engineer Letter
10/19/2023 Letter INSPECTION SUMMARY
12/22/2023 Letter INSPECTION SUMMARY
12/22/2023 Letter INSPECTION SUMMARY
01/03/2024 Letter INSPECTION SUMMARY
01/11/2024 Letter INSPECTION SUMMARY
01/11/2024 Letter INSPECTION SUMMARY
02/06/2024 Letter INSPECTION SUMMARY
03/08/2024 Letter INSPECTION SUMMARY
03/08/2024 Letter INSPECTION SUMMARY
03/08/2024 Letter INSPECTION SUMMARY
03/19/2024 Letter INSPECTION SUMMARY
03/27/2024 Letter INSPECTION SUMMARY
04/04/2024 Letter INSPECTION SUMMARY
05/10/2024 Letter INSPECTION SUMMARY
05/10/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/23/2024 Letter INSPECTION SUMMARY
05/29/2024 Letter INSPECTION SUMMARY
05/29/2024 Letter INSPECTION SUMMARY
07/08/2024 Letter INSPECTION SUMMARY
07/08/2024 Letter INSPECTION SUMMARY
07/16/2024 Letter INSPECTION SUMMARY
07/16/2024 Letter INSPECTION SUMMARY
07/16/2024 Letter INSPECTION SUMMARY
07/17/2024 Letter INSPECTION SUMMARY
07/17/2024 Letter INSPECTION SUMMARY
07/17/2024 Letter INSPECTION SUMMARY
07/23/2024 Plot Plan APPROVED AS BUILT PLOT PLAN
07/24/2024 Letter INSPECTION SUMMARY
07/24/2024 Letter INSPECTION SUMMARY
07/24/2024 Letter Field Certificate of Occupancy
07/24/2024 Letter Codes Final Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
