Permit Application Status

PRPWFR20170794


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRPWFR20170794
Public Works Infrastructure Permit - Residential
Final Acceptance
EAGLE CREEK HOME OWNERS ASSN
DEVELOPMENT COMPLETE
Complete infrastructure for residential development
03/21/2017
06/08/2017
12/05/2019
Locations
Address
2401 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2405 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2409 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2417 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2421 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2425 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2505 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2509 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2513 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2517 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2521 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2525 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2529 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2533 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2537 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2601 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2605 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2609 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2613 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2617 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2621 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2626 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2622 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2618 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2614 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2610 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2606 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2602 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2548 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2544 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2532 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2528 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2524 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2520 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2516 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2512 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2508 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2504 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2500 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2428 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2424 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2420 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2416 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2412 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2408 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2404 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2400 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2536 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Address
2540 SW RIVER TRAIL RD, LEES SUMMIT, MO 64082

Property
69220330300000000

Property
69220341400000000

Property
69220330400000000

Property
69220341300000000

Property
69220330500000000

Property
69220341200000000

Property
69220341100000000

Property
69220330600000000

Property
69220341000000000

Property
69220330700000000

Property
69220330800000000

Property
69220340900000000

Property
69220330900000000

Property
69220331000000000

Property
69220352800000000

Property
69220331100000000

Property
69220352700000000

Property
69220331200000000

Property
69220352600000000

Property
69220331300000000

Property
69220352500000000

Property
69220331400000000

Property
69220352400000000

Property
69220331500000000

Property
69220352300000000

Property
69220331600000000

Property
69220352200000000

Property
69220331700000000

Property
69220352100000000

Property
69220331800000000

Property
69220351300000000

Property
69220352000000000

Property
69220331900000000

Property
69220351900000000

Property
69220351800000000

Property
69220351700000000

Property
69220351400000000

Property
69220351600000000

Property
69220332000000000

Property
69220351500000000

Property
69220332100000000

Property
69220332200000000

Property
69220332900000000

Property
69220332800000000

Property
69220332700000000

Property
69220332600000000

Property
69220332500000000

Property
69220332400000000

Property
69220332300000000

Property
69220333000000000

Address
2150 SW LADDERBACK DR, LEES SUMMIT, MO 64082

Contacts
HUNT MIDWEST REAL EST DEV INC, Address:8300 NE UNDERGROUND DR
SUPERIOR BOWEN CONST LLC, Address:520 W PENNWAY ST STE 300, Phone:(816) 921-8200
REDFORD CONSTRUCTION INC, Address:PO BOX 1065, Phone:(816) 540-2030
JK CONCRETE CONSTRUCTION LLC, Address:PO BOX 159, Phone:(816) 623-3343
RANDY SPALDING EXCAVATING INC, Address:PO BOX 1421, Phone:(816) 318-9500
EAGLE CREEK HOME OWNERS ASSN, Address:8300 NE UNDERGROUND DR STE 100
LUSARDI DEBRA ANN, Address:2400 SW RIVER TRAIL RD
HOOPER CAROLYN M, Address:2404 SW RIVER TRAIL RD
EBY CHRISTOPHER J & COURTNEY L, Address:2408 SW RIVER TRAIL RD
LINDEMANN NICOLE D & KARL J, Address:2412 SW RIVER TRAIL RD
ANDREWS JUSTIN D & KATIE M, Address:2416 SW RIVER TRAIL RD
GENSKY WILLIAM F & ROBYNE G, Address:2420 SW RIVER TRAIL RD
BRADLEY J & MICHELLE R OSBORNE REVOCABLE LIVING TRUST DATED 02-07-2023, Address:2424 SW RIVER TRAIL RD
GEORGE BAMBI GAIL, Address:2428 SW RIVER TRAIL RD
FROELICH TAYLOR S & DANIELLE L, Address:2500 SW RIVER TRAIL RD
ROONEY CAITLIN & YORK MATTHEW, Address:2504 SW RIVER TRAIL RD
RUFF MICHAEL & JAMIE, Address:2508 SW RIVER TRAIL RD
FINKLE PRESTON & ELIZABETH, Address:2512 SW RIVER TRAIL RD
MERRYMAN TAYLOR D & ALLISON M, Address:2516 SW RIVER TRAIL RD
HARSHNER DEREK & MALLORY, Address:2520 SW RIVER TRAIL RD
ROGERS GRETA L & BRENT A, Address:2524 SW RIVER TRAIL RD
GREGORY J THIEL & MARY E THIEL TRUST DATED 12/16/20, Address:2528 SW RIVERTRAIL RD
OLESON DANE ROBERT & AMANDA ALEXIS, Address:2532 SW RIVER TRAIL RD
BENSON LAWRENCE B & JENNIFER, Address:2544 SW RIVER TRAIL RD
CHEKOURAS ATHANASIUS C & KATHY P, Address:2548 SW RIVER TRAIL RD
O'NEILL DOUG J-TRUSTEE, Address:2602 SW RIVER TRAIL RD
MICHELETTI KENNETH P & TIERNEY MARIE, Address:2606 SW RIVER TRAIL RD
DRAWL SHERYL L & THOMAS F, Address:2610 SW RIVER TRAIL RD
CUMMONS PHILIP & RACHEL, Address:2614 SW RIVER TRAIL RD
FLEXMAN KALLIE & JAMES, Address:2618 SW RIVER TRAIL RD
KOON-ANDERSON LANA J & ANDERSON MARK R, Address:2622 SW RIVER TRAIL RD
MARSHALL JENNIFER DAWN, Address:2626 SW RIVER TRAIL RD
ROONEY BRITT BLEGEN & TIMOTHY F, Address:2401 SW RIVER TRAIL RD
WOODS JARED RUSSELL & MINKS BRAIN ARTHUR, Address:2405 SW RIVER TRAIL RD
PUTMAN KEITH A & CHRISTINE M, Address:2409 SW RIVER TRAIL RD
KOSCHMANN HANS B & CHRISTYN C, Address:2417 SW RIVER TRAIL RD
ODEFEY MATTHEW & ROXANNA, Address:2421 SW RIVER TRAIL RD
TEGENKAMP MARCUS A & ASHLEY M, Address:2425 SW RIVER TRAIL RD
HARRIS MICHAEL S & MEGAN A, Address:2505 SW RIVER TRAIL RD
DEIN BRENT & BRITTNEY, Address:2509 SW RIVER TRAIL RD
SUPPENBACH ADAM M & KELSEY M, Address:2513 SW RIVER TRAIL RD
BOYD ALFRED E & JOSLYN R, Address:2517 SW RIVER TRAIL RD
MCSPADDEN ZACHARY & CLAIRE, Address:2521 SW RIVER TRAIL RD
PETERSON CRAIG M & NICHOLE M, Address:2525 SW RIVER TRAIL RD
DEDOVESH ERIC, Address:2529 SW RIVER TRAIL RD
ROWE DANIEL & LINDSEY, Address:2533 SW RIVER TRAIL RD
MCMAHAN RYAN W & ALICEN B, Address:2537 SW RIVER TRAIL RD
DAY RYAN N & LINDSEY C, Address:2601 SW RIVER TRAIL RD
DGHEIM ADEL & ANNA, Address:2605 SW RIVER TRAIL RD
RAGHURAMAN ASHWIN, Address:2609 SW RIVER TRAIL RD
BORJAS-GONZALEZ DIEGO & NICHOLS SAMANTHA, Address:2613 SW RIVER TRAIL RD
WILSON STEPHANIE, Address:2617 SW RIVER TRAIL RD
KINNEY JEFFREY S & JESSICA M, Address:2621 SW RIVER TRAIL RD
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 03/28/2017 06/06/2017
Development Center
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $5,519.91 $5,519.91 Paid 06/06/2017
91100C9-Water Insp Fee $4,291.25 $4,291.25 Paid 06/06/2017
9110072-Water Test Fee $1,000.00 $1,000.00 Paid 06/06/2017
9110068-Storm Fee $3,485.17 $3,485.17 Paid 04/03/2017
9110081-Paved Surface Inspection Fee $11,653.94 $11,653.94 Paid 04/03/2017
9110071-Site Grading Fee $13,969.25 $13,969.25 Paid 04/03/2017
$13,969.26
9110079-After Hours Inspection (Building Codes)(Per Hour) $1,171.06 $1,171.06 Paid 06/25/2019
$1,204.00
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

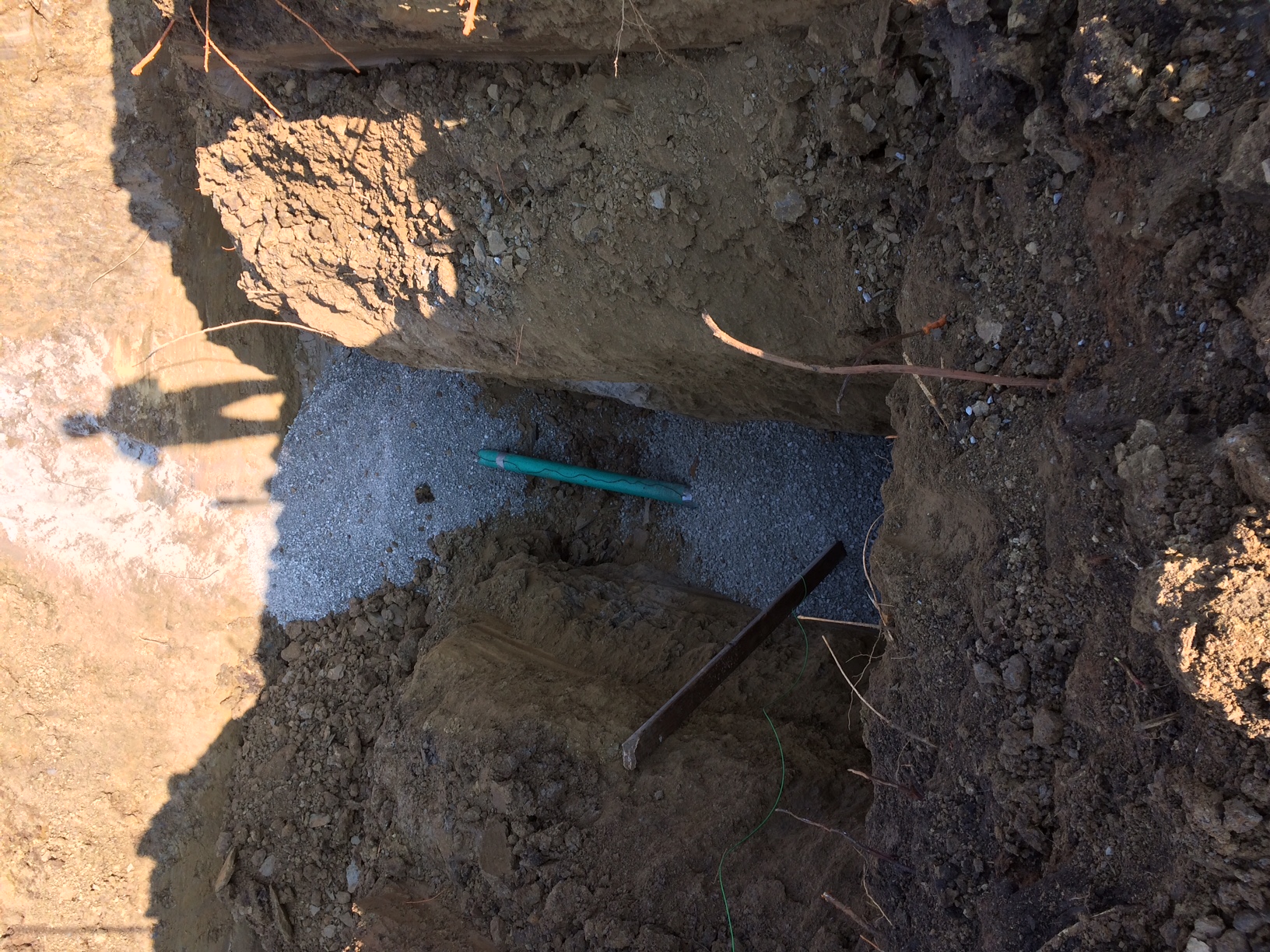

Storm - Rip Rap Partial 8/15/2017 at 10:00 AM 08/15/2017
Informational
08/15/2017
Tom Chandler 08/15/2017 10:55 AM Installed fabric and 1st load of riprap at the end of ES2-1.
Storm - Rip Rap Partial 8/15/2017 at 2:15 PM 08/15/2017
Informational
08/15/2017
Tom Chandler 08/15/2017 2:48 PM Installed 2nd load of riprap at ES 2-1.

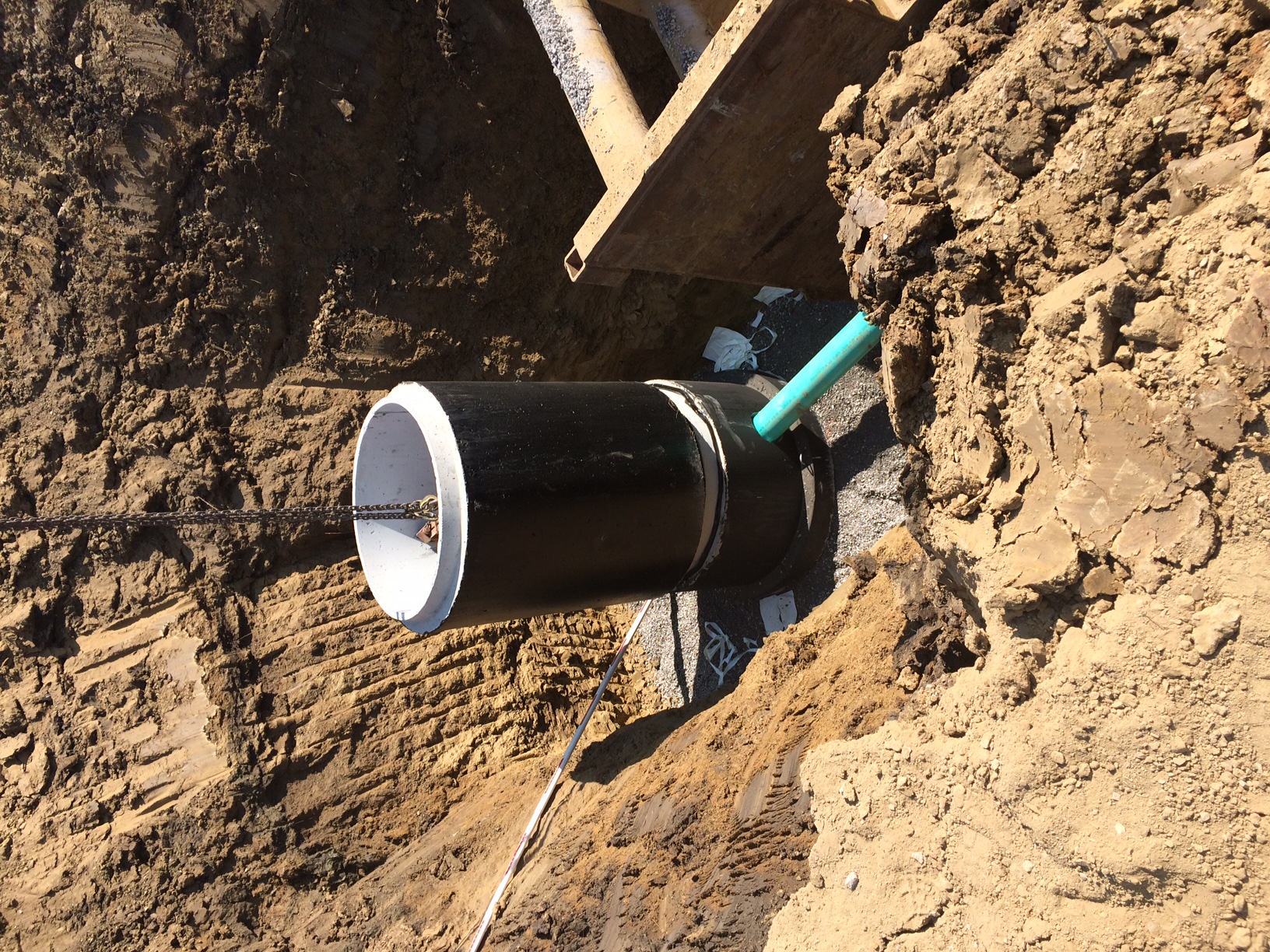

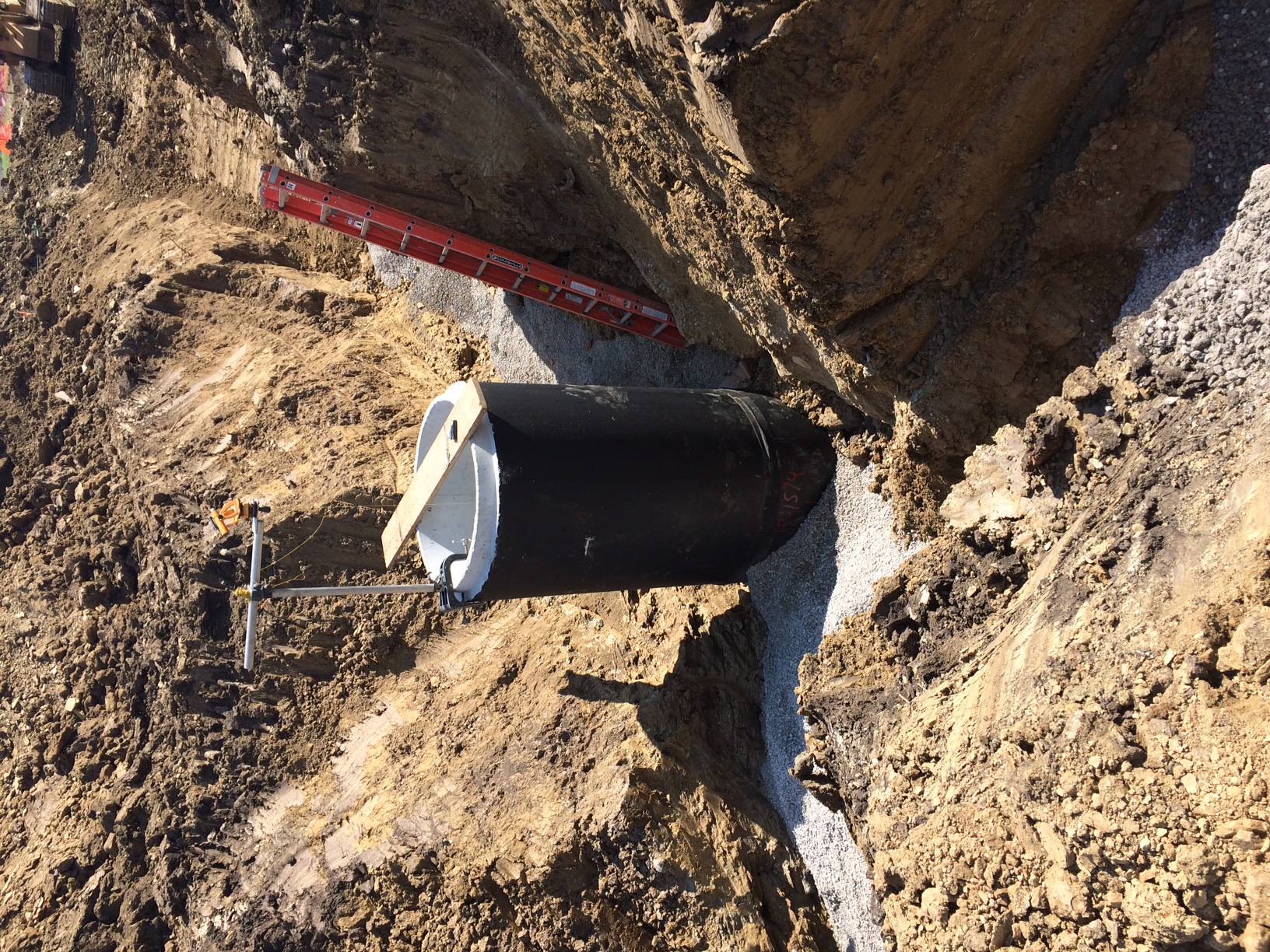

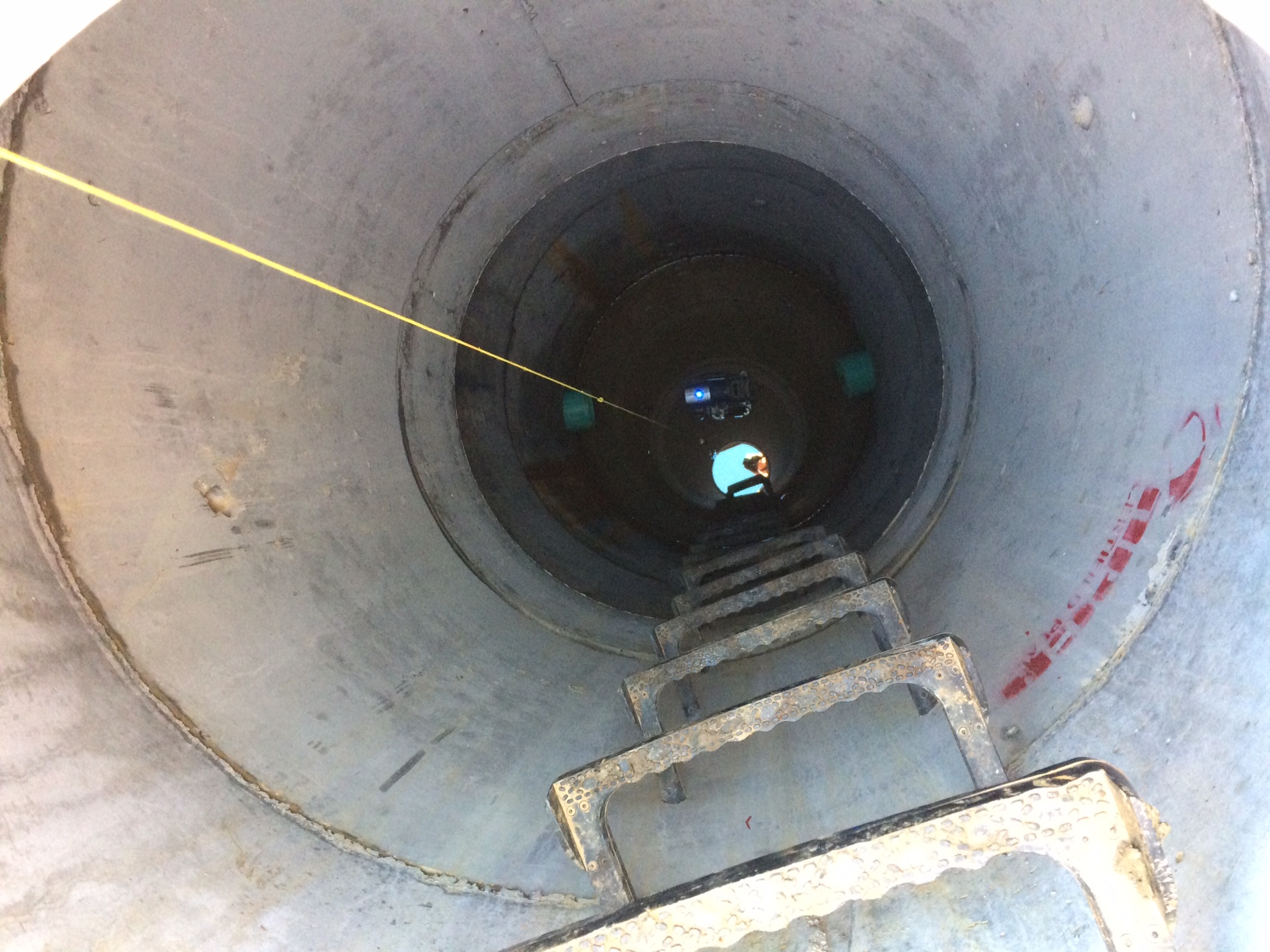

Site Visit Complete 8/16/2017 at 11:30 AM 08/16/2017
Informational
08/16/2017
Tom Chandler 08/16/2017 11:41 AM No work going on today because of rain.

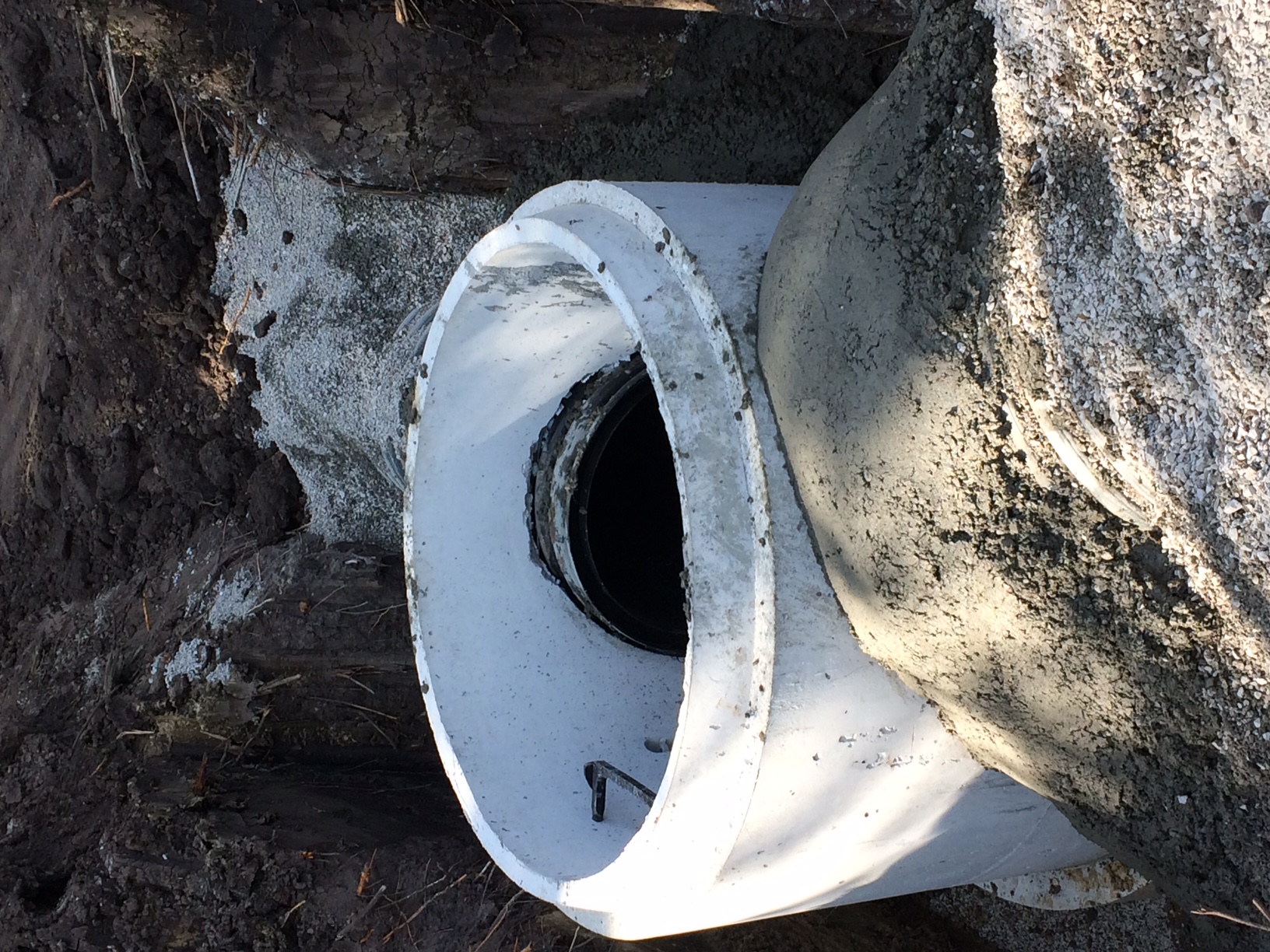

Storm - Pipe Partial 8/8/2017 08/16/2017
Informational
08/16/2017
Tom Chandler 08/08/2017 Approximately 80 L/F of 48" HDPE was installed going from ES 2-1 to MH 2-1a prior to me taking over the project. MH 2-1a was installed and collars and invert poured. 1 stick of 48" HDPE was installed out of MH 2-1a.
Storm - Pipe Partial 8/9/2017 08/16/2017
Informational
08/16/2017
Tom Chandler 08/09/2017 Removed and reinstalled approximately 60 L/F of 48" HDPE pipe from ES 2-1 going towards MH 2-1a. Pipe was egg shaped.
Storm - Pipe Partial 8/10/2017 08/16/2017
Informational
08/16/2017
Tom Chandler 08/10/2017 Installed approximately 120 L/F of 48" HDPE and storm structure CI 2-2. Installed collars and invert on CI 2-2.
Storm - Pipe Partial 8/11/2017 08/16/2017
Informational
08/16/2017
Tom Chandler 08/11/2017 Installed 42"HDPE pipe from CI 2-2 to CI 2-3 and MH 2-4. Installed collars and inverts on CI 2-3 and MH 2-4.
Storm - Pipe Partial 8/14/2017 08/16/2017
Informational
08/16/2017
Tom Chandler 08/14/2017 Installed remaining 42"HDPE pipe to tie into existing 42"HDPE. Removed existing FES and connected pipe using repair coupling. Contractor still needs to stack out CI and MH for storm line 2.

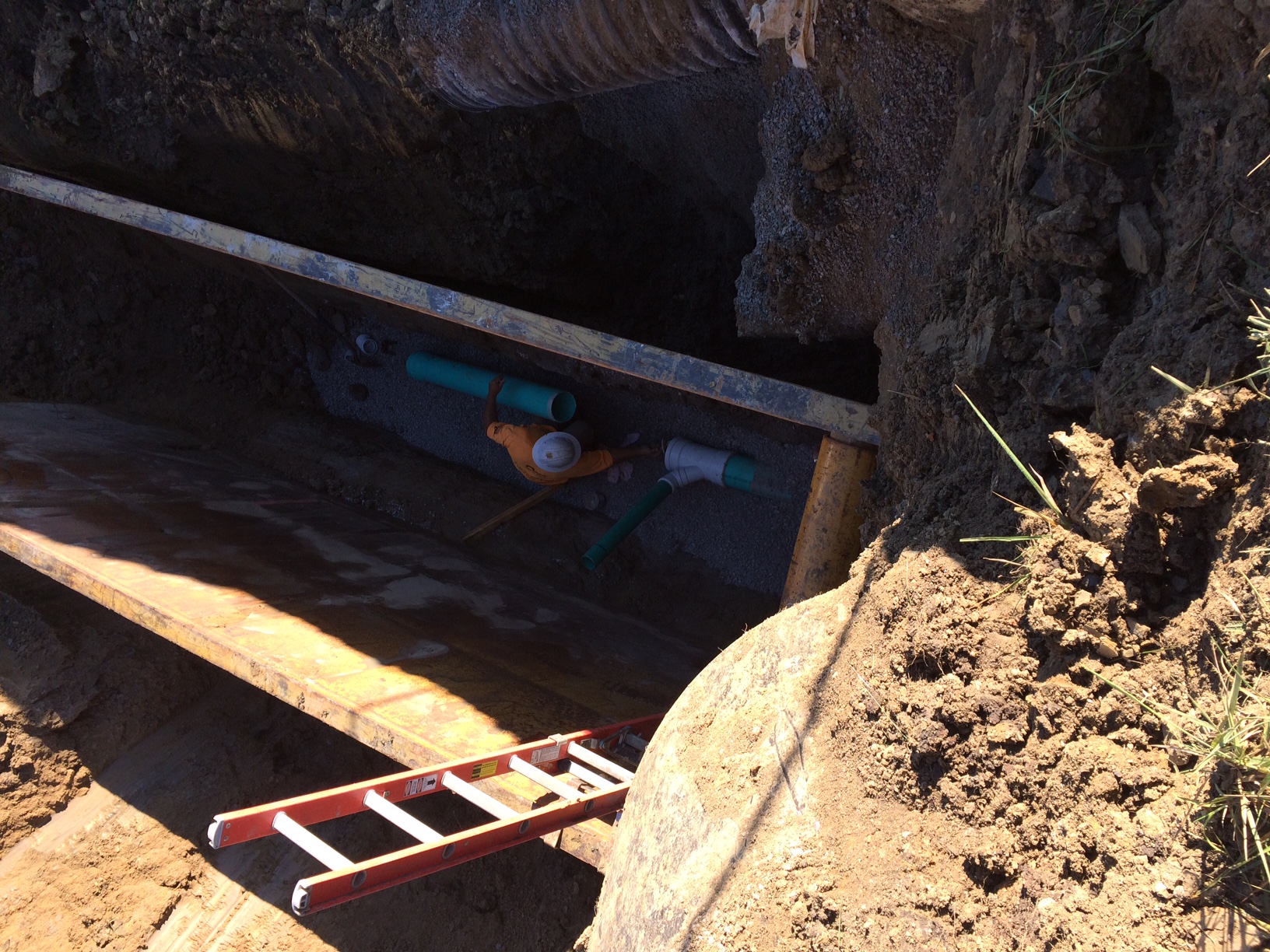

Site Visit Complete 8/17/2017 at 9:30 AM 08/17/2017
Informational
08/17/2017
Tom Chandler 08/17/2017 No work going on. Waiting for structures to stack out and complete Storm sewer lin 2.
Storm - Pipe Partial 8/18/2017 at 9:10 AM 08/18/2017
Informational
08/18/2017
Tom Chandler 08/18/2017 9:50 AM Structures to complete storm sewer line 2 have been delivered. Will stack out structures today.
Storm - Pipe Partial 8/18/2017 at 12:00 PM 08/18/2017
Informational
08/18/2017
Tom Chandler 08/18/2017 2:35 PM Storm sewer structures have stacked out.
Erosion Control Inspection Failed 8/22/2017 at 10:00 AM 08/22/2017
Informational
08/22/2017
Tom Chandler 08/22/2017 10:22 AM ESC devices are not in place along west side of Storm sewer line 2. There needs to be additional ESC devices along the creek in that area.

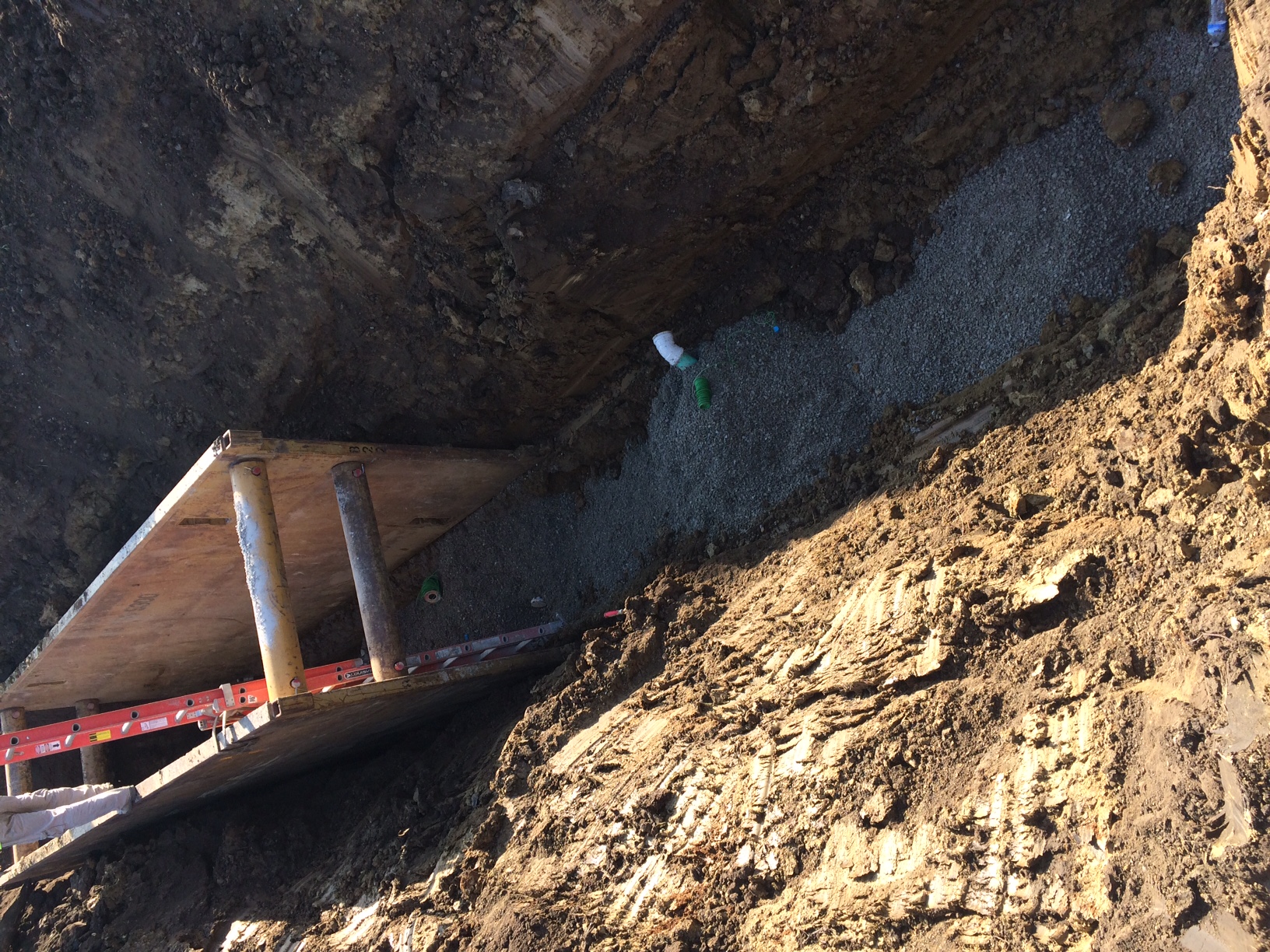

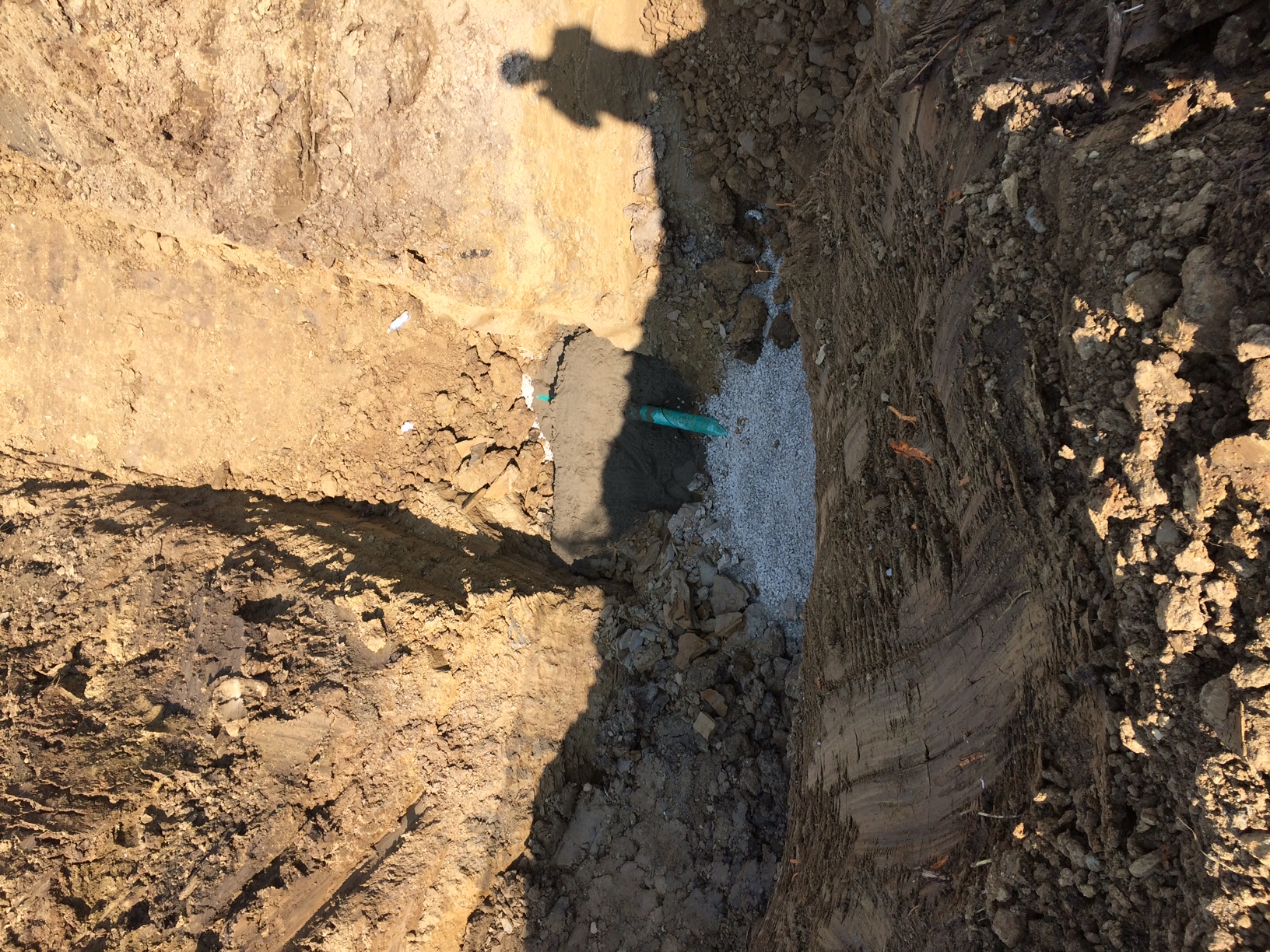

Grading/Excavation/Fill Inspection Partial 8/23/2017 at 9:00 AM 08/23/2017
Informational
08/23/2017
Tom Chandler 08/23/2017 10:01 AM Fill being placed between station 86 and station 88 for roadway today. Olssen was on-site and tested the 1st lift at 9:30AM.
Grading/Excavation/Fill Inspection Partial 8/24/2017 at 9:00 AM 08/24/2017
Informational
08/24/2017
Tom Chandler 08/24/2017 10:07 AM Fill being placed between station 86 and station 88 in roadway and lots. Olsson on-site for testing. (2) lifts were placed on 08/23/2017.
Grading/Excavation/Fill Inspection Partial 8/24/2017 at 11:00 AM 08/24/2017
Informational
08/24/2017
Tom Chandler 08/24/2017 11:48 AM Finished another lift between station 86 and station 88. Olsson on site for testing. Will continue to fill between station 87 and station 89 this afternoon.
Grading/Excavation/Fill Inspection Partial 8/24/2017 at 1:15 PM 08/24/2017
Informational
08/24/2017
Tom Chandler 08/24/2017 2:44 PM Fill being placed in roadway between station 87 and station 89 and lots as well. Testing for lift being placed is scheduled for 9:00AM on 08/25/2017.
Storm - Pipe Partial 8/24/2017 at 2:00 PM 08/24/2017
Informational
08/24/2017
Tom Chandler 08/24/2017 2:47 PM Grout and wrap being installed on Storm sewer structure CI 2-3 between top section and bottom section.
Erosion Control Inspection Passed 8/24/2017 at 8:45 AM 08/25/2017
Informational
08/25/2017
Tom Chandler 08/25/2017 8:53 AM Mulch berm has been constructed along the creek where Storm sewer line 2 was installed. ESC devices have been repaired.
Grading/Excavation/Fill Inspection Partial 8/25/2017 at 9:00 AM 08/25/2017
Informational
08/25/2017
Tom Chandler 08/25/2017 9:06 AM Fill being placed in roadway. Olsson will be on-site for testing this morning to test new lift. Another lift will be placed this afternoon and tested at the end of the day.
Sanitary Sewer Construction Inspection Partial 8/28/2017 at 9:00 AM 08/28/2017
Informational
08/28/2017
Tom Chandler 08/28/2017 9:42 AM Began excavation today at existing MH 1-0. Will connect and begin installing 8" SDR 26 pipe.
Grading/Excavation/Fill Inspection Partial 8/28/2017 at 8:45 AM 08/28/2017
Informational
08/28/2017
Tom Chandler 08/28/2017 9:51 AM Fill being placed in some of the lots on the west side of plat.
Sanitary Sewer Construction Inspection Partial 8/28/2017 at 1:30 PM 08/28/2017
Informational
08/28/2017
Tom Chandler 08/28/2017 3:53 PM excavated around existing MH 1-0 to begin installing new sanitary sewer main. Existing MH had been installed with stub for new development. No invert was installed in existing MH. It was at dead end of the 14th Plat. Contractor hit rock. No pipe was installed today.
Sanitary Sewer Construction Inspection Partial 8/29/2017 at 8:55 AM 08/29/2017
Informational
08/29/2017
Tom Chandler 08/29/2017 9:19 AM Began installing 8" SDR 26 sanitary sewer main and wyes.
Sanitary Sewer Construction Inspection Partial 8/29/2017 at 12:15 PM 08/29/2017
Informational
08/29/2017
Tom Chandler 08/29/2017 2:58 PM Installed service wye and stub for lot 682. Continued installing sanitary sewer main as well.Installed anode at the main and tracer wire along stub. Still have to pour trench check.
Sanitary Sewer Construction Inspection Partial 8/29/2017 at 2:30 PM 08/29/2017
Informational
08/29/2017
Tom Chandler 08/29/2017 3:03 PM Installed sanitary sewer main up to wye for lot 683. Installed wye and stub for lot 683. Installed anode at main and tracer wire along the stub. Still have to pour trench check.Still need to backfill and get testing for lots 682 and 683 in roadway. Olsson showed up for testing backfill in roadway for stub in lots 682 and 683. Installed sanitary main up to and including wye and stub for lot 681.
Sanitary Sewer Construction Inspection Partial 8/30/2017 at 9:00 AM 08/30/2017
Informational
08/30/2017
Tom Chandler 08/30/2017 9:53 AM Contractor has installed sanitary sewer main up to station 11+40. Installed service wyes and stubs for lot 681 and 684. Installed anode at the main and tracer along the stub. Trench checks poured this morning for lots 681-684. Continued installing sanitary sewer main towards MH 1-1.
Sanitary Sewer Construction Inspection Partial 8/30/2017 at 2:45 PM 08/30/2017
Informational
08/30/2017
Tom Chandler 08/30/2017 3:49 PM Installing sanitary sewer main and MH 1-1. Installed wyes and stubs for lots 685 and 680. Installed anode at main and tracer wire along stub. Will install trench checks tomorrow.
Sanitary Sewer Construction Inspection Partial 8/30/2017 at 4:30 PM 08/30/2017
Informational
08/30/2017
Tom Chandler 08/30/2017 4:42 PM Installed sanitary sewer main up to station 12+20. MH 1-1 base and (1) barrell section stacked. Installed joint seal and wrap.
Sanitary Sewer Construction Inspection Partial 8/31/2017 at 8:15 AM 08/31/2017
Informational
08/31/2017
Tom Chandler 08/31/2017 8:28 AM Installed sanitary sewer main up to station 12+50. Installed wyes and stubs for lots 679 and 686. Anode installed at main and along service stubs. Trench checks for lots 679,680,685 and 686 were poured at 10:00AM this morning as well. Continued installing sanitary sewer main up to station 13+20. Installed wyes for lots 678 and 687.
Sanitary Sewer Construction Inspection Partial 8/31/2017 at 12:45 PM 08/31/2017
Informational
08/31/2017
Tom Chandler 08/31/2017 1:00 PM Installing service stubs for lots 678 and 687. Anodes installed at the main and tracer wire ran along stub. Tom Chandler 08/31/2017 3:25 PM Installed sanitary main up to station 13+90. Installed wyes for lots 677 and 688. Installed anodes at the main ran tracer wire along the service stubs. Olsson has showed up for testing backfill in the roadways.Testing for lots 685-688.
Sanitary Sewer Construction Inspection Partial 9/1/2017 at 9:30 AM 09/01/2017
Informational
09/01/2017
Tom Chandler 09/01/2017 9:33 AM Contractor working on backfill over the main in the ROW. Clean up around site and installing lids on Storm sewer line 2 structures. Only working til 11:00 today. Not installing any pipe today.
Sanitary Sewer Construction Inspection Partial 9/5/2017 at 9:55 AM 09/05/2017
Corrective Action Required
09/05/2017
Tom Chandler 09/05/2017 10:08 AM Began installing sanitary sewer main this morning at station 13+90. Installed service wyes and laterals for lots 676 and 689. Stopped at station 15+40. on sanitary main.
Sanitary Sewer Construction Inspection Partial 9/5/2017 at 1:15 PM 09/05/2017
Informational
09/05/2017
Tom Chandler 09/05/2017 1:36 PM Installing service lateral for lot 690. Have installed anode at the main and tracer wire along stubs for lots 676,689, and 690. Will pour trench checks later this afternoon. Olsson showed up at 2:45pm for testing on the roadway crossings for lots 689 and 690.Trench checks poured for lots 676,689,and 690. Stopped installing sanitary main at station 15+80.
Sanitary Sewer Construction Inspection Partial 9/6/2017 at 9:30 AM 09/06/2017
Informational
09/06/2017
Tom Chandler 09/06/2017 10:51 AM Moisture/Density testing at station 14+00 of the Sanitary sewer main. Testing done at station 15+50 for roadway crossing of River Spring Rd. as well.
Storm - Pipe Partial 9/6/2017 at 9:30 AM 09/06/2017
Informational
09/06/2017
Tom Chandler 09/06/2017 10:55 AM Begin construction of Storm sewer line 1 this morning. Started laying pipe at FES 1-1. Installing 30" HDPE pipe.
Storm - Pipe Partial 9/6/2017 at 11:00 AM 09/06/2017
Informational
09/06/2017
Tom Chandler 09/06/2017 12:27 PM Installed FES 1-1 and 73.5ft. of 30" HDPE Storm sewer pipe. Installed MH 1-2 and 30ft. of 30" HDPE pipe before lunch.
Storm - Pipe Partial 9/6/2017 at 1:45 PM 09/06/2017
Informational
09/06/2017
Tom Chandler 09/06/2017 2:30 PM Installed 30" HDPE storm pipe up to CI 1-3. Installed CI 1-3 as well. Tom Chandler 09/06/2017 4:05 PM Installed 34ft. of 30" HDPE storm pipe and CI 1-4. Installed 30ft. of 30" HDPE storm pipe going towards MH 1-5 and stopped. Started pouring collars at 4:00pm. Will install underdrain between CI 1-3 and CI 1-4 at a later date.
Storm - Pipe Partial 9/7/2017 at 9:30 AM 09/07/2017
Informational
09/07/2017
Tom Chandler 09/07/2017 10:18 AM Installed 48ft. 24" HDPE storm pipe between MH 1-5 and existing 24" pipe from existing MH 1-6. Installed the 26ft. of 30" HDPE storm pipe to MH 1-5 from MH 1-4. Will pour collars later in the day.
Sanitary Sewer Construction Inspection Partial 9/7/2017 at 10:00 AM 09/07/2017
Informational
09/07/2017
Tom Chandler 09/07/2017 10:27 AM Began installing Sanitary sewer again this morning from station 15+80. Installed MH 1-2 Drop manhole.
Sanitary Sewer Construction Inspection Partial 9/7/2017 at 1:00 PM 09/07/2017
Informational
09/07/2017
Tom Chandler 09/07/2017 1:31 PM Installed wye and elbow and pipe for Drop MH 1-2. Installed steel and will pour later this afternoon. Installed service wye and stub for lot 675. Installed anode at the main and tracer wire along the stub. Will pour trench check later. Concrete expected at 4:00pm today for drop manhole encasement.
Storm - Pipe Partial 9/7/2017 at 2:50 PM 09/07/2017
Corrective Action Required
09/07/2017
Tom Chandler 09/07/2017 4:46 PM Concrete expected at 4:00pm today for remaining collars and inverts to be poured on Storm sewer line 1.
Sanitary Sewer Construction Inspection Partial 9/8/2017 at 9:00 AM 09/08/2017
Corrective Action Required
09/08/2017
Tom Chandler 09/08/2017 9:46 AM Installed sewer stub for lot 675. Installed anode at the main and tracer wire along the stub. Will pour trench check later this morning. Contractor is only working a half day today. Will not be installing anymore pipe today. Will do clean up and any backfill that is needed.
Storm - Rip Rap Partial 9/8/2017 at 9:45 AM 09/08/2017
Corrective Action Required
09/08/2017
Tom Chandler 09/08/2017 9:51 AM Installed fabric and riprap at FES 1-1.
Storm - Pipe Partial 9/8/2017 at 10:00 AM 09/08/2017
Informational
09/08/2017
Tom Chandler 09/08/2017 9:54 AM Will be pouring inverts on MH 1-2, CI 1-3, CI 1-4, and MH 1-5 at 10:00am.
Sanitary Sewer Construction Inspection Partial 9/11/2017 at 8:25 AM 09/11/2017
Informational
09/11/2017
Tom Chandler 09/11/2017 8:25 AM Began installing sanitary sewer main at stattion 16+40. Installed wyes for lot 674 and 691. Intalled service stubs as well. Installed anode at the main and tracer wire along the stub.
Sanitary Sewer Construction Inspection Partial 9/11/2017 at 11:45 AM 09/11/2017
Informational
09/11/2017
Tom Chandler 09/11/2017 11:47 AM Installed sanitary sewer main up to station 17+10. Will continue towards MH 1-3 after lunch.
Sanitary Sewer Construction Inspection Partial 9/11/2017 at 1:15 PM 09/11/2017
Informational
09/11/2017
Tom Chandler 09/11/2017 1:19 PM Began installing sanitary sewer main at station 17+10. Installed MH 1-3 base and (1) barrell section. Tom Chandler 09/11/2017 4:00 PM Installed sanitary sewer main up to station 17+85. Installed wyes and stubs for lots 673 and 692. Trench checks for lots 673,674,691, and 692 need to be poured. Olsson showed up to test roadway crossings for lots 691 and 692.
Sanitary Sewer Construction Inspection Partial 9/12/2017 at 8:45 AM 09/12/2017
Informational
09/12/2017
Tom Chandler 09/12/2017 8:58 AM Began installing sanitary sewer main at station 17+85. Installed trench checks for service stubs for lots 673,674,691,and 692 this morning.
Sanitary Sewer Construction Inspection Partial 9/12/2017 at 10:40 AM 09/12/2017
Informational
09/12/2017
Tom Chandler 09/12/2017 10:49 AM Installed wyes and service stubs for lots 672 and 693. Installed anodes at the main and tracer wire along the stub. Will pour trench checks this afternoon.
Sanitary Sewer Construction Inspection Partial 9/12/2017 at 12:45 PM 09/12/2017
Informational
09/12/2017
Tom Chandler 09/12/2017 12:56 PM Installing sanitary main.
Sanitary Sewer Construction Inspection Partial 9/12/2017 at 3:35 PM 09/12/2017
Informational
09/12/2017
Tom Chandler 09/12/2017 4:53 PM Installed sanitary sewer main up to station 19+60. Installed service wyes and stubs for lots 670,671,and 694. Installed anodes at the main and tracer wire along the stub. Trench checks were poured for lots 670,671,672,693,and 694. Moisture/Density testing done on Sanitary main station 18+00 and roadway crossing for lots 693 and 694.
Sanitary Sewer Construction Inspection Partial 9/13/2017 at 9:30 AM 09/13/2017
Informational
09/13/2017
Tom Chandler 09/13/2017 11:30AM Began installing sanitary sewer main at station 19+60. Installed service wye and service stub for lot 695. Installed anode at the main and tracer wire along the stub. Will pour trench check later this afternoon. Installed Sanitary sewer main up to 20+22 and installed MH 1-4.
Sanitary Sewer Construction Inspection Partial 9/13/2017 at 1:00 PM 09/13/2017
Informational
09/13/2017
Tom Chandler 09/13/2017 1:45 PM Installed up to station 20+50. Installed wyes and service stubs for lots 669 and 696. Installed anodes at the main and ran tracer wire along the stubs.
Sanitary Sewer Construction Inspection Partial 9/13/2017 at 3:35 PM 09/13/2017
Informational
09/13/2017
Tom Chandler 09/13/2017 3:38 PM Installed sanitary sewer main up to station 21+00. Installed wye and service stub for lot 697. Installed anode at the main and tracer wire along the stub. Poured trench checks for lots 669,670,695,696,and 697. Moisture/density testing done for roadway crossings for lots 695 and 697.
Sanitary Sewer Construction Inspection Partial 9/14/2017 at 8:30 AM 09/14/2017
Informational
09/14/2017
Tom Chandler 09/14/2017 10:05 AM Began installing sanitary sewer main at station 21+00. Installed wyes and service stubs for lots 668 and 698. Installed anodes at the main and ran tracer wire along the stubs. Will pour trench checks this afternoon.
Sanitary Sewer Construction Inspection Partial 9/14/2017 at 12:45 PM 09/14/2017
Informational
09/14/2017
Tom Chandler 09/14/2017 2:34 PM Installed wyes and service stubs for lots 667 and 699. Installed anodes at the main and ran tracer wire along the stubs. Olsson was on site at 3:00pm to do moisture/density testing for roadway crossings for lots 697 and 698. Will pour trench checks for lots 667,668,697,and 698 at 4:30pm. Stopped installing sanitary sewer main at station 22+30.
Sanitary - Material Verification Partial 9/14/2017 at 12:00 AM 09/14/2017
Informational
09/14/2017
Tom Chandler 09/14/2017 4:28 PM Dead end MH 1-7 has opening future Sanitary sewer main. Talked to contractor about getting a new base for MH 1-7. He is going order new base and invert will be poured after installation.
Sanitary Sewer Construction Inspection Partial 9/15/2017 at 9:45 AM 09/15/2017
Informational
09/15/2017
Tom Chandler 09/15/2017 10:23 AM Installed sanitary sewer main up to MH 1-5 at station 22+75. Backfill on sanitary main.
Sanitary Sewer Construction Inspection Partial 9/19/2017 at 10:45 AM 09/19/2017
Informational
09/19/2017
Tom Chandler 09/19/2017 Began installing sanitary sewer main at MH 1-5. MH 1-5 stationing at 22+75.46. Service stub for lot 700 calls out stationing at 22+75.46 as well. Moved stub approximately 5ft out of MH 1-5. Installed service stub for lot 666 as well. Installed anodes at the main and ran tracer wire along the stub. Will pour trench checks this afternoon at 4pm.
Sanitary Sewer Construction Inspection Partial 9/19/2017 at 1:30 PM 09/19/2017
Informational
09/19/2017
Tom Chandler 09/19/2017 1:50 PM Installed sanitary sewer main up to station 23+75. Installed wyes and service stubs for lots 665 and 701. Installed anodes at the main and tracer wire along the stubs.
Sanitary Sewer Construction Inspection Partial 9/19/2017 at 3:45 PM 09/19/2017
Informational
09/19/2017
Tom Chandler 09/19/2017 4:05 PM Installed sanitary sewer main up to station 24+20. Installed wyes and service stubs for lot 702. Trench checks poured at 4:30pm for lots 665,666,700,701, and 702.
Sanitary Sewer Construction Inspection Partial 9/20/2017 at 9:00 AM 09/20/2017
Informational
09/20/2017
Tom Chandler 09/20/2017 9:17 AM Began installing sanitary sewer main at station 24+20 this morning. Olsson showed up ar 9:15 to perform moisture/denstiy testing for roadway crossings for lots 701-702. Installed up to statiion 24+80. Installed wyes and service stubs for lots 664 and 703. Installed anodes at the main and tracer wire along the stubs.
Sanitary Sewer Construction Inspection Partial 9/20/2017 at 1:15 PM 09/20/2017
Informational
09/20/2017
Tom Chandler 09/20/2017 2:52 PM Installed sanitary sewer main up to station 25+30. Installed MH 1-6 and stacked barrell sections as well. Installed wye and service line for lot 704. Installed anode at the main and tracer wire along the stub. Olsson back on-site for moisture/density testing for roadway crossing for lot 703 and sanitary sewer main at station 23+00. Will pour trench checks later today.
Sanitary Sewer Construction Inspection Partial 9/20/2017 at 3:45 PM 09/20/2017
Informational
09/20/2017
Tom Chandler 09/20/2017 4:09 PM Installed trench checks for lots 664,703,and 704. Moisture density testing for roadway crossing for lot 704 completed as well.
Sanitary Sewer Construction Inspection Partial 9/21/2017 at 8:30 AM 09/21/2017
Informational
09/21/2017
Tom Chandler 09/21/2017 8:39 AM Began installing sanitary sewer main at station 25+30.
Sanitary Sewer Construction Inspection Partial 9/21/2017 at 12:45 PM 09/21/2017
Informational
09/21/2017
Tom Chandler 09/21/2017 12:55 PM Sanitary main installed up to station 26+26. Wyes and service stubs installed for lots 662,663,and 705. Anodes installed at the main and tracer wire along the stubs. Trench checks will be poured later this afternoon. Olsson on-site for moisture/density testing for lot 705.
Sanitary Sewer Construction Inspection Partial 9/21/2017 at 3:00 PM 09/21/2017
Informational
09/21/2017
Tom Chandler 09/21/2017 3:06 PM Installed up to station 26+75. Installed wye and service stub for lot 706. Installed anode at the main and ran tracer wire along the stub. Will pour trench checks for lots 662,663,705,and 706 at 4:30 today.MH 1-6 was wrapped and adjusted to grade.
Sanitary Sewer Construction Inspection Partial 9/22/2017 at 9:00 AM 09/22/2017
Informational
09/22/2017
Tom Chandler 09/22/2017 8:56 AM Began installing sanitary sewer main at station 26+75 this morning. Installed up to station 27+20. Installed wyes and service lines for lot 661 and 707. Installed anodes at the main and tracer wire ran along the stubs. Will pour trench checks at 11:00am.
Sanitary Sewer Construction Inspection Partial 9/22/2017 at 2:15 PM 09/22/2017
Informational
09/22/2017
Tom Chandler 09/22/2017 2:20 PM Installed trench checks for lots 706 and 707. Olsson on-site for moisture/density testing for lots 706 and 707. Stopped at station 27+50. Began hitting rock around station 27+20.
Sanitary Sewer - Invert Partial 9/22/2017 at 2:15 PM 09/22/2017
Informational
09/22/2017
Tom Chandler 09/22/2017 2:25 PM Poured inverts for MH 1-4 and MH 1-5.
Sanitary Sewer Construction Inspection Partial 9/25/2017 at 9:00 AM 09/25/2017
Informational
09/25/2017
Tom Chandler 09/25/2017 4:12 PM Began installing Sanitary sewer main at station 27+50. Still having to break rock.
Sanitary Sewer Construction Inspection Passed 9/25/2017 at 3:00 PM 09/25/2017
Informational
09/25/2017
Tom Chandler 09/25/2017 4:14 PM Finished installing Sanitary sewer main this afternoon. Installed MH 1-7 and stcked it out and wrapped it as well.
Water Line - Construction Inspection Partial 9/26/2017 at 8:30 AM 09/26/2017
Informational
09/26/2017
Tom Chandler 09/26/2017 1:15 PM Installed 8" tee at station 10+86 of Water line 1. Installed 20ft. south of the tee and capped. Installed 80ft. of 8" water main of Water line 3 off of tee. Installed 20ft. north of tee for Water line 1. Installed 8" gate valve for Water line 3 at station 10+00. Used epoxy coated fittings and glands. Used 3M spray on blue bolts and poly wrapped with 12 mil. clear poly.
Water Line - Construction Inspection Partial 9/26/2017 at 1:00 PM 09/26/2017
Corrective Action Required
09/26/2017
Tom Chandler 09/26/2017 1:29 PM Installed Water line 1 up to station 10+00. Installed 8" valve and reducer to temporary hydrant. Will pour Thrust blocks and straddle blocks tomorrow. Installed tracer wire and marking tape as well. Installed 8" tee at station 23+86 for Water line 1 and Water linie 2. Installed 20ft. of 8" c900 on each side of tee for Water line 1 and capped off. Will pour thrust block tomorrow. Installed epoxy coated fittings and blue bolts. Sprayed black 3M coating on bolts and wrapped with 12ml clear poly wrapped.
Water Line - Construction Inspection Partial 9/27/2017 at 7:45 AM 09/27/2017
Informational
09/27/2017
Tom Chandler 09/27/2017 08:45am Installed 55ft of 8" c900 for Water line 2 coming off of tee. Capped end of line. Ran tracer wire along with marking tape. Will pour thrust blocks at 4:00pm today for water line tees and hydrant. Will pour straddle block as well.
Storm - Rip Rap Partial 9/27/2017 at 9:30 AM 09/27/2017
Informational
09/27/2017
Tom Chandler 09/27/2017 10:40 AM Installed geotextile fabric and rip rap according to the calculations on plans for Storm sewer line 4.
Storm - Pipe Partial 9/27/2017 at 9:30 AM 09/27/2017
Informational
09/27/2017
Tom Chandler 09/27/2017 10:37 AM Began construction of Storm sewer line 4. Installing FES 4-1 and 15" HDPE storm pipe.
Storm - Pipe Partial 9/27/2017 at 1:00 PM 09/27/2017
Informational
09/27/2017
Tom Chandler 09/27/2017 1:37 PM Installed 72ft. of 15" HDPE storm pipe and MH 4-2. Installed up to station 12+50.
Storm - Pipe Partial 9/27/2017 at 3:45 PM 09/27/2017
Informational
09/27/2017
Tom Chandler 09/27/2017 4:01 PM Installed storm line 4 up to station 13+00.
Storm - Pipe Partial 9/28/2017 at 9:30 AM 09/28/2017
Informational
09/28/2017
Tom Chandler 09/28/2017 9:56 AM Completed storm sewer line 4 to include CI 4-3 and CI 4-4. Will pour collars and inverts later. Began installing Storm sewer line 3.
Storm - Pipe Partial 9/28/2017 at 3:00 PM 09/28/2017
Informational
09/28/2017
Tom Chandler 09/28/2017 3:46 PM Installed storm sewer line 3 up to station 12+00. Installed ES 3-1 and MH 3-2 and CI 3-3. Will pour collars and inverts later.
Sanitary - Material Verification Passed 9/22/2017 10/02/2017
Informational
10/02/2017

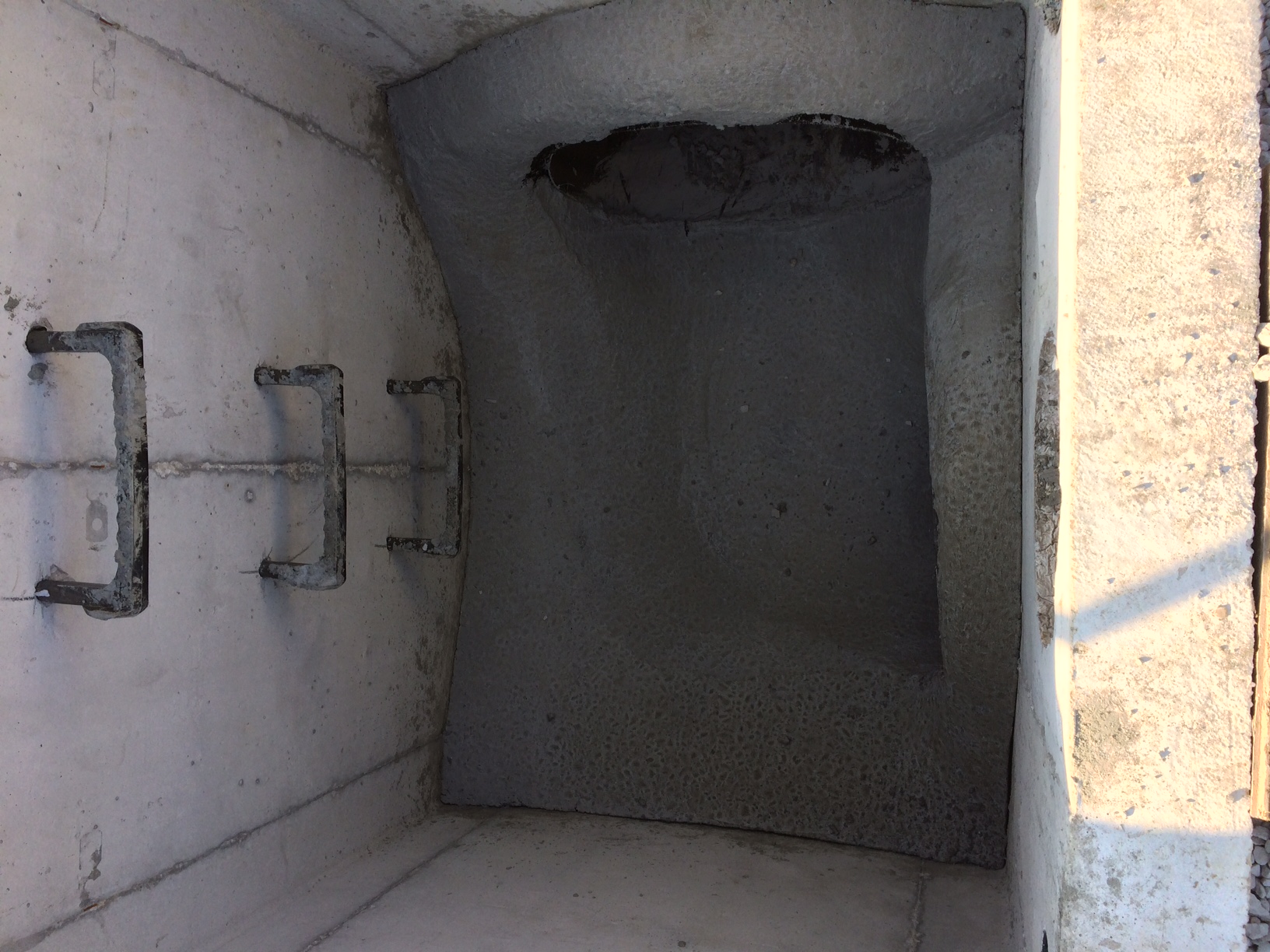

Tom Chandler 10/02/2017 1:25 PM MH 1-7 base was replaced with the proper base for dead end manhole. Previous MH 1-7 had opening for future stub. This was also on the plans as well.
Storm - Pipe Passed 10/2/2017 at 8:30 AM 10/02/2017
Informational
10/02/2017
Tom Chandler 10/02/2017 1:28 PM Began installing storm sewer line 3. Installed 15" HDPE pipe from CI 3-3 towards CI 3-4. Installed CI 3-4 and poured collars at 11:00am this morning.
Storm - Rip Rap Passed 10/2/2017 at 9:00 AM 10/02/2017
Informational
10/02/2017
Tom Chandler 10/02/2017 1:31 PM Installed rip rap per calculation for ES 3-1.
Sanitary Sewer - Invert Partial 10/2/2017 at 11:00 AM 10/02/2017
Informational
10/02/2017
Tom Chandler 10/02/2017 1:33 PM remaining sanitary sewer inverts were poured starting at 11:00am this morning.
Water Line - Valve Partial 10/2/2017 at 8:30 AM 10/02/2017
Informational
10/02/2017
Tom Chandler 10/02/2017 1:37 PM Spoke to Heath with Redford Construction about valve needed on Water Line 1. Plans show valve at station 10+00 and the next valve at station 24+00. Valve needed at minimum every 1000ft. per Design and Construction Manual. Confirmed with Gene Williams this morning.
Pavement-Stabilized Subgrade Partial 10/19/2017 at 8:00 AM 10/19/2017
Informational
10/19/2017
Tom Chandler 10/19/2017 2:45 PM Installing fly ash for subgrade stabilization. Olsson on-site for testing as well. Installing 9" on Ladderback drive and 6" on River Trail road. Installed fly ash up to station 89+50 on River Trail road. Will continue on River Trail road tomorrow.
Pavement-Stabilized Subgrade Passed 10/20/2017 at 7:45 AM 10/20/2017
Informational
10/20/2017
Tom Chandler 10/20/2017 8:11 AM Fly ash being installed for remainder of project today. Olsson is on-site for testing as well.
Pavement-Proof Roll Partial 10/25/2017 at 10:15 AM 10/25/2017
Informational
10/25/2017
Tom Chandler 10/25/2017 10:47 AM Proof rolled fly ash stabilized subgrade up to station 84+00 on River Trail rd. and on Ladderback drive. Will begin laying base rock this afternoon. Will proof roll again tomorrow for remaining roads.
Pavement-Aggregate Base Partial 10/25/2017 at 3:45 PM 10/25/2017
Informational
10/25/2017
Tom Chandler 10/25/2017 3:51 PM Olsson on-site for testing of type 5 base rock installed on Ladderback drive.
Sanitary Sewer - Air Test Passed 10/26/2017 at 8:00 AM 10/30/2017
Informational
10/30/2017
Tom Chandler 10/26/2017 Air tested Sanitary sewer main according to specs in Design and Construction manual. All sections passed for the amount of time specified for the length of line tested . 7:36 was the minimum amount of time for testing.
Sanitary Sewer - Vacuum Passed 10/26/2017 at 8:00 AM 10/30/2017
Informational
10/30/2017
Tom Chandler 10/26/2017 Vacuum testing completed for amount of time specified in the Design and Construction manual. Minimum time was 2:00. All manholes passed testing.
Curb - Proof Roll Passed 10/30/2017 at 8:00 AM 10/30/2017
Curb - Compression Strength Partial 10/30/2017 10/30/2017
Informational
10/30/2017
Tom Chandler 10/30/2017 3:05 PM Olsson has been on-site to perform multiple test as various intervals for curb installation.
Sanitary Sewer - Mandrel Passed 11/1/2017 at 10:00 AM 10/31/2017
Informational
10/31/2017
Tom Chandler 10/31/2017 1:54 PM Mandrel testing done on sanitary sewer main. All sanitary sewer testing has been completed and main has been flushed as well.
Curb - Compression Strength Partial 10/31/2017 at 8:00 AM 10/31/2017
Informational
10/31/2017
Tom Chandler 10/31/2017 1:56 PM Remainder of curb has been installed and throats completed by hand today as well.
Pavement-Proof Roll Passed 11/2/2017 at 2:00 PM 11/03/2017
Informational
11/03/2017
Tom Chandler 11/03/2017 9:25 AM Proof rolled aggregate base and string lined for asphalt paving to begin on 11/03/2017.
Pavement-Aggregate Base Passed 10/26/2017 11/03/2017
Informational
11/03/2017
Tom Chandler 11/03/2017 9:27 AM MoDot type 5 aggregate base completed. Olsson testing on-site as well.
Grading/Excavation/Fill Inspection Passed 11/2/2017 11/03/2017
Informational
11/03/2017
Tom Chandler 11/03/2017 9:29 AM Backfilling behind curbs has been completed.
Curb - Compression Strength Passed 10/31/2017 11/03/2017
Informational
11/03/2017
Tom Chandler 11/03/2017 9:31 AM Curb has been completed and tested.
Pavement-Surface Passed 11/3/2017 at 9:30 AM 11/03/2017
Informational
11/03/2017
Tom Chandler 11/03/2017 9:32 AM Superior Bowen began place base lift this morning at 9:30AM. Type 1 asphalt being installed. Subgrade tempature was 42 degrees. Air tempature was 40 and rising when asphalt installation began. High expected to reach 51 degrees today. Surface will be installed on 11/04/2017.
Street - Wedge Lift Passed 11/4/2017 at 8:30 AM 11/04/2017
Informational
11/04/2017
Tom Chandler 11/04/2017 8:51 AM Contractor on-site to prepare for installation of Type 2 asphalt wedge lift. Existing asphalt has been milled back and tack coat has been applied. Existing base asphalt temperature is 57 degrees and outside air temperature is 47 and rising. Hi temperature expected to reach 57 degrees today. 1.5" lift to be placed.
Street - Surface Course Passed 11/4/2017 at 11:45 AM 11/04/2017
Informational
11/04/2017
Tom Chandler 11/04/2017 4:29 PM Type 3V asphalt was installed this afternoon. Air temperature was 49 and rising at beginning of installation. Surface temperature was 57 degrees.
Miscellaneous PWORKS Inspection Partial 11/7/2017 11/07/2017
Informational
11/07/2017
Tom Chandler 11/07/2017 10:35 AM Water Utilities on-site today for video inspection of Sanitary sewer system.
Miscellaneous PWORKS Inspection Partial 11/10/2017 11/13/2017
Informational
11/13/2017
Tom Chandler 11/13/2017 9:08 AM Called and emailed the utilities contractor with the results of the video inspection from the water utilittes department. There is (1) small sag and some debris in the main that needs to be corrected as well as (8) service wyes that need to be corrected to meet the 30-45 degree limits.
Miscellaneous PWORKS Inspection Partial 11/14/2017 11/14/2017
Informational
11/14/2017
Tom Chandler 11/14/2017 Contractor on-site to make repairs noted in the video inspection of sanitary sewer.
Miscellaneous PWORKS Inspection Partial 11/15/2017 at 8:45 AM 11/15/2017
Informational
11/15/2017
Tom Chandler 11/15/2017 9:49 AM Repairs are being made to wyes installed past the 45 degree maximum allowed angle. Will pour trench checks later today that are needed as well.
Miscellaneous PWORKS Inspection Partial 11/15/2017 11/15/2017
Informational
11/15/2017
Tom Chandler 11/15/2017 4:24 PM All the wyes to be corrected have been corrected. Backfill has been done. Will flush line again as well.
Water Line - Construction Inspection Partial 11/16/2017 at 9:00 AM 11/16/2017
Informational
11/16/2017
Tom Chandler 11/16/2017 9:45 AM Began construction of water line again today.
Water Line - Construction Inspection Partial 11/20/2017 at 10:00 AM 11/21/2017
Informational
11/21/2017
Installed water main 1 from station 29+30 to station 24+00. Installted tees for hydrants and capped. Will install hydrants later. Installed water main 2 and removed temporary hydrant and installed sleeve to make connection to existing water main.
Water Line - Construction Inspection Partial 11/16/2017 at 1:00 PM 11/21/2017
Informational
11/20/2017
Tom Chandler 11/16/2017 Installed water main 1 from station 23+70 to station 16+85. Installed the additional valve not on the plans at station 17+10. Capped lines for the night. Will install hydrants later.
Water Line - Construction Inspection Partial 11/17/2017 at 12:30 PM 11/21/2017
Informational
11/21/2017
Installed water main 1 from station 16+85 to station 11+00. Installed tee and capped. Will installe hydrant later.
Water Line - Construction Inspection Partial 11/21/2017 at 10:30 AM 11/21/2017
Informational
11/21/2017
Tom Chandler 11/21/2017 4:55 PM Installed water main 3. Will installed straddle blocks and thrust blocks tomorrow.
Miscellaneous PWORKS Inspection Passed 11/16/2017 11/21/2017
Informational
11/21/2017
Sag was removed section of sanitary sewer main noted in video inspection. Will retest in 30 days.
Water Line - Construction Inspection Passed 11/27/2017 at 9:00 AM 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 2:04 PM Water main has been completed. Hydrostatic pressure test will be done this afternoon.
Water Line - Valve Passed 11/27/2017 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 2:06 PM Additional valve added at station at station 17+10. Needed the valve to meet the required minimum distance between valves.
Water Line - Thrust Restraint Passed 11/27/2017 at 9:00 AM 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 2:09 PM All thrust blocks and straddle blocks have been completed.
Water Line - Fire Hydrant Partial 11/27/2017 at 9:00 AM 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 2:11 PM All hydrants have been installed. They were installed as straight set and thrust blocks have been poured.
Water Line - Hydrostatic Test Passed 11/27/2017 at 1:30 PM 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 2:13 PM Hydrostatic testing began at 2:00 pm today. Testing at 150psi. Tom Chandler 11/27/2017 4:11 PM Held 150psi for 2 hours.
Miscellaneous PWORKS Inspection Partial 11/27/2017 at 4:15 PM 11/27/2017
Informational
11/27/2017
Tom Chandler 11/27/2017 4:15 PM Chlorinating water main for water testing this week.
Water Line - Coliform Test 1 Failed 12/5/2017 at 1:30 PM 12/08/2017
Informational
12/08/2017
Took water samples today for day 1 sampling. Took 3 samples on River Trail rd and 1 sample on River Spring rd and 1 sample on Ladderback dr.
Water Line - Coliform Test 2 Failed 12/6/2017 at 2:30 PM 12/08/2017
Informational
12/08/2017
Took same 5 samples today. Yesterdays samples had Failed sample from #3 sample on River Trail rd. #2 and #3 sample Failed on River Trail rd on second attempt. Will begin rechlorination process on Friday 12/8/2017.
Water Line - Coliform Test 1 Partial 12/11/2017 at 12:00 PM 12/11/2017
Informational
12/11/2017
Tom Chandler 12/11/2017 1:29 PM Pulled samples for Day 1 testing and took to lab. Will pull day 2 samples tomorrow if day 1 pass. 5 samples and 1 duplicate taken.
Miscellaneous PWORKS Inspection Partial 12/11/2017 at 12:00 PM 12/11/2017
Informational
12/11/2017
Tom Chandler 12/11/2017 1:33 PM Inspected forms and compacted aggregate form ADA ramps.
Water Line - Coliform Test 2 Partial 12/12/2017 at 1:45 PM 12/12/2017
Corrective Action Required
12/12/2017
Tom Chandler 12/12/2017 3:07 PM Took day 2 samples for testing. Day 1 samples passed.
Water Line - Coliform Test 2 Passed 12/13/2017 at 3:00 PM 12/14/2017
Informational
12/14/2017
Tom Chandler 12/14/2017 4:01 PM Lab called to notify of test results of day 2 testing. Test results passed and emailed results to Water Utilities as well. Contractor is wanting to do the tie-ins of Monday 12/18/2017.
Miscellaneous PWORKS Inspection Passed 12/15/2017 at 9:45 AM 12/15/2017
Informational
12/15/2017
Tom Chandler 12/15/2017 9:58 AM Hung door hanger notifications for disruption of water service on Monday 12/18/2017 at 8:00AM for tie-in of water main for Eagle Creek 15th Plat. 2630 and 2634 SW River Trail road will be out of service.
Water Line - Coliform Test 1 Passed 12/13/2017 at 3:30 PM 12/18/2017
Informational
12/18/2017
Tom Chandler 12/13/2017 Lab called and emailed test results for Day 2 testing of the water line. All test have passed and water line will be connected on Monday 12/18/2017.
Miscellaneous PWORKS Inspection Partial 12/18/2017 at 8:15 AM 12/18/2017
Informational
12/18/2017
Tom Chandler 12/18/2017 8:41 AM Water main tie-in has began on SW River Trail road.
Sanitary Sewer - Mandrel Passed 12/15/2017 at 2:30 PM 12/19/2017
Informational
12/19/2017
Tom Chandler 12/19/2017 3:09 PM Mandreled line were sag was at between MH 50-281 and MH 50-280.
Sanitary Sewer - Air Test Passed 12/15/2017 at 2:00 PM 12/19/2017
Informational
12/19/2017
Tom Chandler 12/19/2017 3:04 PM Air test where the wyes were repaired on the main. Tested between 50-275 and 50-278. Tested between existing MH 50-274 and 50-281.
Storm - Inlets Clean Passed 1/3/2018 at 9:15 AM 01/03/2018
Miscellaneous PWORKS Inspection Passed 01/03/2018
Storm - Swales Partial 2/26/2018 at 8:30 AM 02/26/2018
Informational
02/26/2018
Tom Chandler 02/26/2018 8:50 AM Storms swale 7 appears to have been installed according to plan. Will verify when As-graded MDP is received. Storm swale 8 does not appear to be installed at this time.
Site Visit Partial 3/1/2018 at 9:00 AM 03/01/2018
Informational
03/01/2018
Tom Chandler 03/01/2018 9:31 AM Gas company on-site installing the gas main.
ESC - (Vegetation/Ground Cover) Failed 3/5/2018 at 7:50 AM 03/05/2018
PW-Misc
Corrective Action Required
03/05/2018
Tom Chandler 03/05/2018 8:16 AM Stabilzation of construction site needed.
Erosion Control Inspection Failed 3/5/2018 at 7:50 AM 03/05/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/05/2018
There are problems with the erosion control devices on your site. Tom Chandler 03/05/2018 8:19 AM Additional devices needed to site until stabization has been completed.
Corrective Action Required
03/19/2018
Site Visit Partial 3/5/2018 at 7:50 AM 03/05/2018
Informational
03/05/2018
Tom Chandler 03/05/2018 8:11 AM Gas company on-site installing gas main.
Erosion Control Inspection Failed 3/19/2018 at 12:15 PM 03/19/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/05/2018
There are problems with the erosion control devices on your site. Tom Chandler 03/05/2018 8:19 AM Additional devices needed to site until stabization has been completed.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/19/2018
There are problems with the erosion control devices on your site.Tom Chandler 03/19/2018 3:47 PM Repairs needed to existing devices.
Erosion Control Inspection Failed 3/27/2018 at 10:30 AM 03/27/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/19/2018
There are problems with the erosion control devices on your site. Tom Chandler 03/05/2018 8:19 AM Additional devices needed to site until stabization has been completed.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/19/2018
There are problems with the erosion control devices on your site.Tom Chandler 03/19/2018 3:47 PM Repairs needed to existing devices.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/27/2018
There are problems with the erosion control devices on your site.Tom Chandler 03/27/2018 10:48 AM The swales are not installed according to plan and no stablization in the swales as well. Entire site has no stabilization.
Erosion Control Inspection Failed 4/3/2018 at 9:25 AM 04/03/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/27/2018
There are problems with the erosion control devices on your site. Tom Chandler 03/05/2018 8:19 AM Additional devices needed to site until stabization has been completed.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/27/2018
There are problems with the erosion control devices on your site.Tom Chandler 03/19/2018 3:47 PM Repairs needed to existing devices.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/27/2018
There are problems with the erosion control devices on your site.Tom Chandler 03/27/2018 10:48 AM The swales are not installed according to plan and no stablization in the swales as well. Entire site has no stabilization.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
04/03/2018
There are problems with the erosion control devices on your site. Tom Chandler 04/03/2018 9:28 AM Stabization is needed for the site. Stockpiles of soil have no protection or stabilzation to protect from runoff. Swale that has been installed has no stabilization or ESC devices to maintain the structure.
Storm - Swales Partial 5/7/2018 at 2:00 PM 05/07/2018
PW-Misc
Informational
05/07/2018
Tom Chandler 05/07/2018 3:39 PM Working on swale #8 on the 15th plat.
Install Street and Stop Signs Passed 05/21/2018
Sanitary Sewer - Invert Passed 05/21/2018
Water Line - Fire Hydrant Passed 05/21/2018
Storm - Swales Passed 5/17/2018 05/21/2018
PW-Misc
Informational
05/07/2018
Tom Chandler 05/07/2018 3:39 PM Working on swale #8 on the 15th plat.
Documents & Images
Date Uploaded File Type Document Name
04/03/2017 Certificate/License DE-Daily Inspection Summary
06/06/2017 Receipt Receipt for transaction: 2017-003547
08/15/2017 Letter PW-Daily Inspection Summary
08/16/2017 Letter PW-Daily Inspection Summary
08/16/2017 Letter PW-Permit
08/17/2017 Letter PW-Daily Inspection Summary
08/18/2017 Letter PW-Daily Inspection Summary
08/18/2017 Letter PW-Daily Inspection Summary
08/22/2017 DOC082217-08222017084418
08/22/2017 Letter PW-Daily Inspection Summary
08/24/2017 Letter PW-Daily Inspection Summary
08/24/2017 Letter PW-Daily Inspection Summary
08/25/2017 Letter PW-Daily Inspection Summary
08/25/2017 Letter PW-Daily Inspection Summary
08/29/2017 IMG_0929
08/29/2017 IMG_0928
08/29/2017 Letter PW-Daily Inspection Summary
08/30/2017 IMG_0935
08/30/2017 IMG_0938
08/30/2017 Letter DE-Daily Inspection Summary
08/31/2017 IMG_0939
08/31/2017 Letter DE-Daily Inspection Summary
09/01/2017 Letter DE-Daily Inspection Summary
09/05/2017 Letter DE-Daily Inspection Summary
09/06/2017 IMG_0942
09/06/2017 Letter DE-Daily Inspection Summary
09/07/2017 Letter DE-Daily Inspection Summary
09/08/2017 Letter DE-Daily Inspection Summary
09/11/2017 Letter DE-Daily Inspection Summary
09/12/2017 Letter DE-Daily Inspection Summary
09/13/2017 Letter DE-Daily Inspection Summary
09/14/2017 Letter DE-Daily Inspection Summary
09/19/2017 Letter DE-Daily Inspection Summary
09/20/2017 Letter DE-Daily Inspection Summary
09/21/2017 IMG_0959
09/21/2017 IMG_0953
09/21/2017 IMG_0949
09/21/2017 Letter DE-Daily Inspection Summary
09/22/2017 Letter DE-Daily Inspection Summary
09/25/2017 Letter DE-Daily Inspection Summary
09/26/2017 Letter DE-Daily Inspection Summary
09/27/2017 Letter DE-Daily Inspection Summary
09/28/2017 Letter DE-Daily Inspection Summary
10/02/2017 Letter DE-Daily Inspection Summary
10/19/2017 Letter DE-Daily Inspection Summary
10/20/2017 Letter DE-Daily Inspection Summary
10/25/2017 Letter DE-Daily Inspection Summary
10/30/2017 Letter DE-Daily Inspection Summary
10/31/2017 Letter DE-Daily Inspection Summary
11/03/2017 Letter DE-Daily Inspection Summary
11/04/2017 Letter DE-Daily Inspection Summary
11/13/2017 Letter DE-Daily Inspection Summary
11/14/2017 Letter DE-Daily Inspection Summary
11/15/2017 Letter DE-Daily Inspection Summary
11/21/2017 Letter DE-Daily Inspection Summary
11/27/2017 Letter DE-Daily Inspection Summary
12/11/2017 Letter DE-Daily Inspection Summary
12/12/2017 Letter DE-Daily Inspection Summary
12/14/2017 WOR16876
12/14/2017 Letter DE-Daily Inspection Summary
12/15/2017 Letter DE-Daily Inspection Summary
12/19/2017 Letter DE-Daily Inspection Summary
01/04/2018 Letter DE-Punch List
01/04/2018 DOC010418-01042018104155
02/26/2018 Letter DE-Daily Inspection Summary
03/01/2018 Letter DE-Daily Inspection Summary
03/05/2018 Letter DE-Daily Inspection Summary
03/19/2018 Letter DE-Daily Inspection Summary
03/27/2018 Letter DE-Daily Inspection Summary
04/03/2018 Letter DE-Daily Inspection Summary
04/04/2018 Letter DE-Daily Inspection Summary
04/20/2018 Letter DE-Daily Inspection Summary
05/07/2018 Letter DE-Daily Inspection Summary
05/21/2018 Letter DE-Certificate of Substantial Completion Multiple Lot
05/21/2018 Letter DE-Punch List
05/22/2018 SSE_recorded_HMRED
06/25/2019 Receipt Receipt for transaction: 2019-004086
09/27/2019 Letter DE-Permit
10/28/2019 Eagle Creek 15th Plat Maintenance Bond and Affidavit
12/05/2019 Eagle Creek 15th Plat Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
