Permit Application Status

PRCOM20222245


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20222245
Building Permit - Commercial
Certificate of Occupancy
STAR ACQUISITIONS & DEVELOPMENT LLC
NEW COMMERCIAL
NEW COFFEE SHOP WITH DRIVE-UP SERVICE
05/23/2022
09/07/2022
12/04/2022
05/31/2023
Locations
Contacts
Accel Construction, LLC, Address:4015 N. Woodlawn Ct. Suite 1, Phone:(316) 706-8724
kevino@accelconstructionks.com, Address:kevino@accelconstructionks.com, Phone:(316) 282-2385
METALCRAFT INC, Address:5138 MERRIAM DR., Phone:(913) 707-8824
Crockett Electric, Address:4651 Brewer Pl
RODINA COMPANY INC, Address:1204 N 59TH ST, Phone:(913) 334-5336
TORGERSON DESIGN PARTNERS, Address:116 N 2ND AVE, Phone:(479) 640-8444
STAR ACQUISITIONS & DEVELOPMENT LLC, Address:244 W MILL STE 101
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/30/2022 08/22/2022
Joe Frogge
LC - General Contractor
Resolved
08/22/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent. 6/27/22 - acknowledged in letter
LC - MEP Subs
Resolved
08/22/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 6/27/22 - acknowledged in letter
Health Department Review Approved 08/08/2022
Mike Weisenborn
Building Plan Review Approved with Conditions 06/30/2022 08/05/2022
Joe Frogge
Health Dept Review
Resolved
08/05/2022

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes. 6/27/22 - acknowledged in letter
Health Dept Inspection
Corrective Action Required
06/23/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes. 6/27/22 - acknowledged in letter
Code analysis required
Resolved
06/27/2022

A code analysis shall be provided which includes but is not limited to occupancy type, occupant load, construction type, actual area, height and floors, allowable area, height and floors, and the codes to which the project is designed. Action required: Include cooler and attic in square foot calculation and use gross areas. (I calc 800s.f.)
Final Development Plan
Resolved
08/03/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 6/27/22 - acknowledged in letter
Planning - Screening of rooftop equipment
Corrective Action Required
06/27/2022

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section. (needs to be by parapet) 6/27/22 - parapets added. Field verify efficacy
IBC 1015.6 Mechanical equipment, systems and devices - hvac within 10 feet of roof edge
Corrective Action Required
06/23/2022

2018 IBC 1015.6 Mechanical equipment, systems and devices. Guards shall be provided where various components that require service are located within 10 feet of a roof edge or open side of a walking surface and such edge or open side is located more than 30 inches above the floor, roof or grade below. The guard shall extend not less than 30 inches beyond each end of such components. The guard shall be constructed so as to prevent the passage of a sphere 21 inches in diameter. Action required: Provide fall protection near condensing units. 6/27/22 - resolved by adding anchorage connector - field verify
Misc
Resolved
06/27/2022

2018 IBC 1202.4 Under-floor ventilation. The space between the bottom of the floor joists and the earth under any building except spaces occupied by basements or cellars shall be provided with ventilation in accordance with Section 1202.4.1, 1202.4.2 or 1202.4.3. Action required: Modify designs to comply. Include ventilation scenario and vapor barrier.
Final Development Plan Review Approved 08/05/2022 08/03/2022
Mike Weisenborn
Fire Plan Review Approved 06/30/2022 06/27/2022
Jim Eden
Fire Plan Review Approved 06/07/2022 06/07/2022
Jim Eden
Misc
Corrective Action Required
06/07/2022

The adopted Fire Code for the City of Lee's Summit is the 2018 International Fire Code. For information only.
Building Plan Review Rejected 06/07/2022 05/25/2022
Joe Frogge
Health Dept Review
Corrective Action Required
05/23/2022

For the Health Department review contact Deb Sees with the Jackson County Public Works Department, Environmental Services Division, at (816) 847-7070. Health Department approval is required prior to receiving any type of building permit from the City of Lee's Summit. Action required: Comment is for informational purposes.
Health Dept Inspection
Corrective Action Required
05/23/2022

For the Health Department inspection contact Deb Sees with the Jackson County Public Works Department, Environmental Health Division at (816) 847-7070. Health Department approval is required prior to receiving any type of Occupancy from the City of Lee's Summit. Action required: Comment is for informational purposes.
Code analysis required
Corrective Action Required
05/23/2022

A code analysis shall be provided which includes but is not limited to occupancy type, occupant load, construction type, actual area, height and floors, allowable area, height and floors, and the codes to which the project is designed. Action required: Include cooler and attic in square foot calculation and use gross areas. (I calc 800s.f.)
Final Development Plan
Corrective Action Required
05/25/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
Planning - Screening of rooftop equipment
Corrective Action Required
05/25/2022

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: Make needed corrections to drawings that provide details as to how mechanical equipment will be screened from all 4 sides per referenced UDO section. (needs to be by parapet)
IBC 1015.6 Mechanical equipment, systems and devices - hvac within 10 feet of roof edge
Corrective Action Required
05/25/2022

2018 IBC 1015.6 Mechanical equipment, systems and devices. Guards shall be provided where various components that require service are located within 10 feet of a roof edge or open side of a walking surface and such edge or open side is located more than 30 inches above the floor, roof or grade below. The guard shall extend not less than 30 inches beyond each end of such components. The guard shall be constructed so as to prevent the passage of a sphere 21 inches in diameter. Action required: Provide fall protection near condensing units.
Misc
Corrective Action Required
05/25/2022

2018 IBC 1202.4 Under-floor ventilation. The space between the bottom of the floor joists and the earth under any building except spaces occupied by basements or cellars shall be provided with ventilation in accordance with Section 1202.4.1, 1202.4.2 or 1202.4.3. Action required: Modify designs to comply. Include ventilation scenario and vapor barrier.
Licensed Contractors Rejected 06/07/2022 05/25/2022
Joe Frogge
LC - General Contractor
Corrective Action Required
05/25/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Corrective Action Required
05/25/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $3,000.00 $3,000.00 Paid 08/24/2022
8331507-Sewer Connection Fee $180.00 $180.00 Paid 08/24/2022
7232302-Commercial License Tax Fee $11,752.50 $11,752.50 Paid 05/03/2023
9110073-Right of Way Permit Fee $85.00 $85.00 Paid 08/11/2022
8331401-Water Tap Fee $15,845.00 $15,845.00 Paid 08/11/2022
$16,160.00
8350015-Water Meter Fee $1,349.38 $1,349.38 Paid 08/11/2022
$1,489.66
9110071-Site Grading Fee $1,820.82 $1,820.82 Paid 08/11/2022
91100C9-Water Insp Fee $260.70 $260.70 Paid 08/11/2022
91100C8-Sanitary Sewer Insp Fees $89.10 $89.10 Paid 08/11/2022
9110081-Paved Surface Inspection Fee $4,171.98 $4,171.98 Paid 08/11/2022
9110068-Storm Fee $518.82 $518.82 Paid 08/11/2022
9110069-After Hours Inspections (Public Works)(Per Hour) $200.00 $200.00 Paid 05/03/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 05/08/2023
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Footing Inspection - Commercial Passed 9/20/2022 (10:00) 9/20/2022 09/20/2022
Misc
Informational
09/20/2022
FOOTING PER PLAN OK TO POUR UFER ACCESS REAR WALL IN CRAWL SPACE
Site Visit Partial 09/22/2022
Misc
Informational
09/22/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued.
Foundation Inspection - Commercial Passed 9/23/2022 (10:00) 9/23/2022 09/23/2022
Site Visit Partial 10/05/2022
Misc
Informational
09/22/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued. 10/05/22 Wednesday JMJ Contractor continued to work on site and building footing.
Footing Inspection - Commercial Partial 10/10/2022 10/10/2022 10/10/2022
Misc
Informational
10/10/2022
- TRASH ENCLOSURE FOOTING OK TO POUR -
Erosion Control Inspection Residential Partial 10/25/2022
Misc
Informational
10/25/2022
10/25/22 Tuesday JMJ Fencing needs to be re-staked in some area to the North on project.
Site Visit Partial 10/25/2022
Misc
Informational
10/05/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued. 10/05/22 Wednesday JMJ Contractor continued to work on site and building footing. 10/25/22 Tuesday JMJ Contractor installed dumpster walls and balliard poles.
Storm Sewer Construction Inspection Partial 11/16/2022
Misc
Informational
11/16/2022
11/16/22 Wednesday JMJ ( Reike Grading ) Contractor installed approximately 60’ of 12” HDPE storm main. Existing storm box was cut into to install new 12” HDPE storm pipe.
Storm Sewer Construction Inspection Partial 11/17/2022
Misc
Informational
11/16/2022
11/16/22 Wednesday JMJ ( Reike Grading ) Contractor installed approximately 60’ of 12” HDPE storm main. Existing storm box was cut into to install new 12” HDPE storm pipe. 11/17/22 Thursday JMJ ( Reike Grading ) Continued the installation of 12” HDPE storm main approximately 75’ & storm box A-2 as-per plan.
Storm Sewer Construction Inspection Partial 11/18/2022
Misc
Informational
11/17/2022
11/16/22 Wednesday JMJ ( Reike Grading ) Contractor installed approximately 60’ of 12” HDPE storm main. Existing storm box was cut into to install new 12” HDPE storm pipe. 11/17/22 Thursday JMJ ( Reike Grading ) Continued the installation of 12” HDPE storm main approximately 75’ & storm box A-2 as-per plan. 11/18/22 Friday JMJ ( Reike Grading ) Contractor installed approximately 90’ of 12” HDPE storm pipe heading toward storm box A-1. All excavation was backfilled around pipe. Contractor is excavating area to install A-1 on Monday of next week.
Storm Sewer Construction Inspection Partial 11/21/2022
Misc
Informational
11/18/2022
11/16/22 Wednesday JMJ ( Reike Grading ) Contractor installed approximately 60’ of 12” HDPE storm main. Existing storm box was cut into to install new 12” HDPE storm pipe. 11/17/22 Thursday JMJ ( Reike Grading ) Continued the installation of 12” HDPE storm main approximately 75’ & storm box A-2 as-per plan. 11/18/22 Friday JMJ ( Reike Grading ) Contractor installed approximately 90’ of 12” HDPE storm pipe heading toward storm box A-1. All excavation was backfilled around pipe. Contractor is excavating area to install A-1 on Monday of next week. 11/21/22 Monday JMJ ( Reike Grading ) Contractor installed approximately 20’ of 6” HDPE storm pipe coming out of A-1 for roof drains. Contractor has concrete coming @ 4:00PM for collars and inverts on storm boxes.;
Water Service Inspection Partial 11/22/2022
Misc
Informational
11/22/2022
11/22/22 Tuesday ( Reike Grading ) Contractor will be working on the domestic water line. Water main was exposed for tie-in, a tee with 6” valve on the property side already exist. Water does not have this in their records and will research before they deliver meter ( because no tap is needed).
Erosion Control Inspection Residential Partial 11/22/2022
Misc
Informational
11/22/2022
11/22/22 Tuesday JMJ ( Reike ) Silt fencing on the Northside of project must be stabled to post. The erosion control measure are effectively working at site.
Sewer Service Inspection Partial 11/29/2022
Misc
Informational
11/29/2022
11/29/22 Tuesday JMJ Contractor installed approximately 150’ of 4” SDR-26 sanitary pipe. Contractor did not backfill do to the wetness of soil.
Sewer Service Inspection Partial 11/30/2022
Misc
Informational
11/29/2022
11/29/22 Tuesday JMJ Contractor installed approximately 150’ of 4” SDR-26 sanitary pipe. Contractor did not backfill do to the wetness of soil.
Misc
Informational
11/30/2022
11/30/22 Wednesday Contractor working on the installation of grease trap.
Site Visit Partial 11/30/2022
Misc
Informational
10/25/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued. 10/05/22 Wednesday JMJ Contractor continued to work on site and building footing. 10/25/22 Tuesday JMJ Contractor installed dumpster walls and balliard poles. 11/30/22 Wednesday JMJ Talked with contractor about using Geogrid in areas that asphalt was going to be laid. I instructed the contractor to review the approved list of Geogrid. Contractor mentioned to survey crew that they will probably have to install hydrant.
Underslab Plumbing Inspection - Commercial Partial 12/1/2022 12/1/2022 12/01/2022
Misc
Corrective Action Required
12/01/2022
Grease interceptor and sanitary lines run to outside of building- -Provide cleanouts outside of building
Site Visit Partial 12/01/2022
Misc
Informational
11/30/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued. 10/05/22 Wednesday JMJ Contractor continued to work on site and building footing. 10/25/22 Tuesday JMJ Contractor installed dumpster walls and balliard poles. 11/30/22 Wednesday JMJ Talked with contractor about using Geogrid in areas that asphalt was going to be laid. I instructed the contractor to review the approved list of Geogrid. Contractor mentioned to survey crew that they will probably have to install hydrant. 12/01/22 Thursday JMJ Contractor worked on backfilling excavation (sanitary).
Water Service Inspection Partial 12/02/2022
Misc
Informational
11/22/2022
11/22/22 Tuesday ( Reike Grading ) Contractor will be working on the domestic water line. Water main was exposed for tie-in, a tee with 6” valve on the property side already exist. Water does not have this in their records and will research before they deliver meter ( because no tap is needed). 12/02/22 Friday ( Reike Grading ) Contractor began to layout 1” copper line. Contractor will be searching for 1” tap that is shown on GIS map runs to the outside of the road.
Pavement-Stabilized Subgrade Partial 12/03/2022
Misc
Informational
12/03/2022
12/03/22 Saturday JMJ ( Complete Excavation ) Observing that the contractor removes soil that has been adversely effected by the inclement seasonal weather and replace with materials that can maintain a quality subgrade. Contractor is using shot rock and AB3/MODOT 5 to obtain a stable ground to possibly pour concrete and lay asphalt throughout the project. City inspector and the third party Alpha & Omega testing will witness a proof roll at some future date. See photos of stabilization efforts on this date in Documents and Images. Continued to observe the process of stabilizing subgrade additional photos add to the library.
Water Line - Construction Inspection Partial 12/05/2022
Misc
Informational
12/05/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building.
Storm Sewer Construction Inspection Partial 12/05/2022
Misc
Informational
11/21/2022
11/16/22 Wednesday JMJ ( Reike Grading ) Contractor installed approximately 60’ of 12” HDPE storm main. Existing storm box was cut into to install new 12” HDPE storm pipe. 11/17/22 Thursday JMJ ( Reike Grading ) Continued the installation of 12” HDPE storm main approximately 75’ & storm box A-2 as-per plan. 11/18/22 Friday JMJ ( Reike Grading ) Contractor installed approximately 90’ of 12” HDPE storm pipe heading toward storm box A-1. All excavation was backfilled around pipe. Contractor is excavating area to install A-1 on Monday of next week. 11/21/22 Monday JMJ ( Reike Grading ) Contractor installed approximately 20’ of 6” HDPE storm pipe coming out of A-1 for roof drains. Contractor has concrete coming @ 4:00PM for collars and inverts on storm boxes. 12/05/22 Monday JMJ ( Reike Grading ) Contractor working installing 6” HDPE storm pipe and Nyloplast for roofing and storm run-off.
Underslab Plumbing Inspection - Commercial Passed 12/6/2022 12/6/2022 12/06/2022
Misc
Resolved
12/06/2022
Grease interceptor and sanitary lines run to outside of building- -Provide cleanouts outside of building
Pavement-Stabilized Subgrade Partial 12/12/2022
Misc
Informational
12/03/2022
12/12/22 Monday JMJ Talked with contractor about get the approved Geogrid product before the began stabilization of subgrade. Contractor was able to installed approved product BOSTD RX1200 and MODOT 5.
Sanitary Sewer Construction Inspection Partial 12/12/2022
Misc
Informational
12/12/2022
12/12/20 Monday JMJ Contractor installed outside Sanitary clean-outs on the outside of building. Two clean out on the West side of building and one on the Eastside. All three clean-outs where 4” white PVC sanitary pipe.
Water Line - Construction Inspection Partial 12/14/2022
Misc
Informational
12/05/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made.
Water Line - Construction Inspection Partial 12/15/2022
Misc
Informational
12/14/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today.
Water Line - Construction Inspection Partial 12/16/2022
Misc
Informational
12/15/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today. 12/16/22 Friday JMJ Contractor continued work on completing the installed of 6” water line and hydrant.
Water Line - Construction Inspection Partial 12/19/2022
Misc
Informational
12/16/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today. 12/16/22 Friday JMJ Contractor continued work on completing the installed of 6” water line and hydrant. 12/19/22 Monday JMJ ( Rienke Construction ) Contractor chlorinated water line on Sunday 12/18/22 2:00PM the de-chlorination will happen today at 2:00PM.
Water Line - Hydrostatic Test Passed 12/19/2022
Misc
Informational
12/19/2022
12/19/22 Monday JMJ ( Reike Grading ) Passed 2hr hydrostatic test.
Water Line - Construction Inspection Partial 12/19/2022
Misc
Informational
12/19/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today. 12/16/22 Friday JMJ Contractor continued work on completing the installed of 6” water line and hydrant. 12/19/22 Monday JMJ ( Rienke Construction ) Contractor chlorinated water line on Sunday 12/18/22 2:00PM the de-chlorination will happen today at 2:00PM. De-chlorination started @ 3:10 PM .
Water Line - Construction Inspection Partial 12/20/2022
Misc
Informational
12/19/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today. 12/16/22 Friday JMJ Contractor continued work on completing the installed of 6” water line and hydrant. 12/19/22 Monday JMJ (Rieke Grading ) Contractor chlorinated water line on Sunday 12/18/22 2:00PM the de-chlorination will happen today at 2:00PM. De-chlorination started @ 3:10 PM . 12/20/22 Tuesday JMJ ( Rieke Grading ) Contractor took the first water sample today @ 9:00 AM.
Footing Inspection - Commercial Failed 12/21/2022 12/21/2022
Misc
Informational
10/10/2022
- TRASH ENCLOSURE FOOTING OK TO POUR - 12/21/22-HAVE REVISED FOUNDATION PLAN ON SITE FOR THE 4 CANOPY PIERS; CLEAN OUT ALL LOOSE DIRT AND TRASH; INSTALL 3 #3 TIES AT UPPER END OF PIERS; MIN 3" CLEARANCE OF REBAR FROM SOIL
Erosion Control Inspection Residential Partial 12/22/2022
Misc
Informational
11/22/2022
11/22/22 Tuesday JMJ ( Reike ) Silt fencing on the Northside of project must be stabled to post. The erosion control measure are effectively working at site. 12/22/22 Thursday JMJ ( Reike ) Erosion control functioning at the time of inspection 3:10PM.

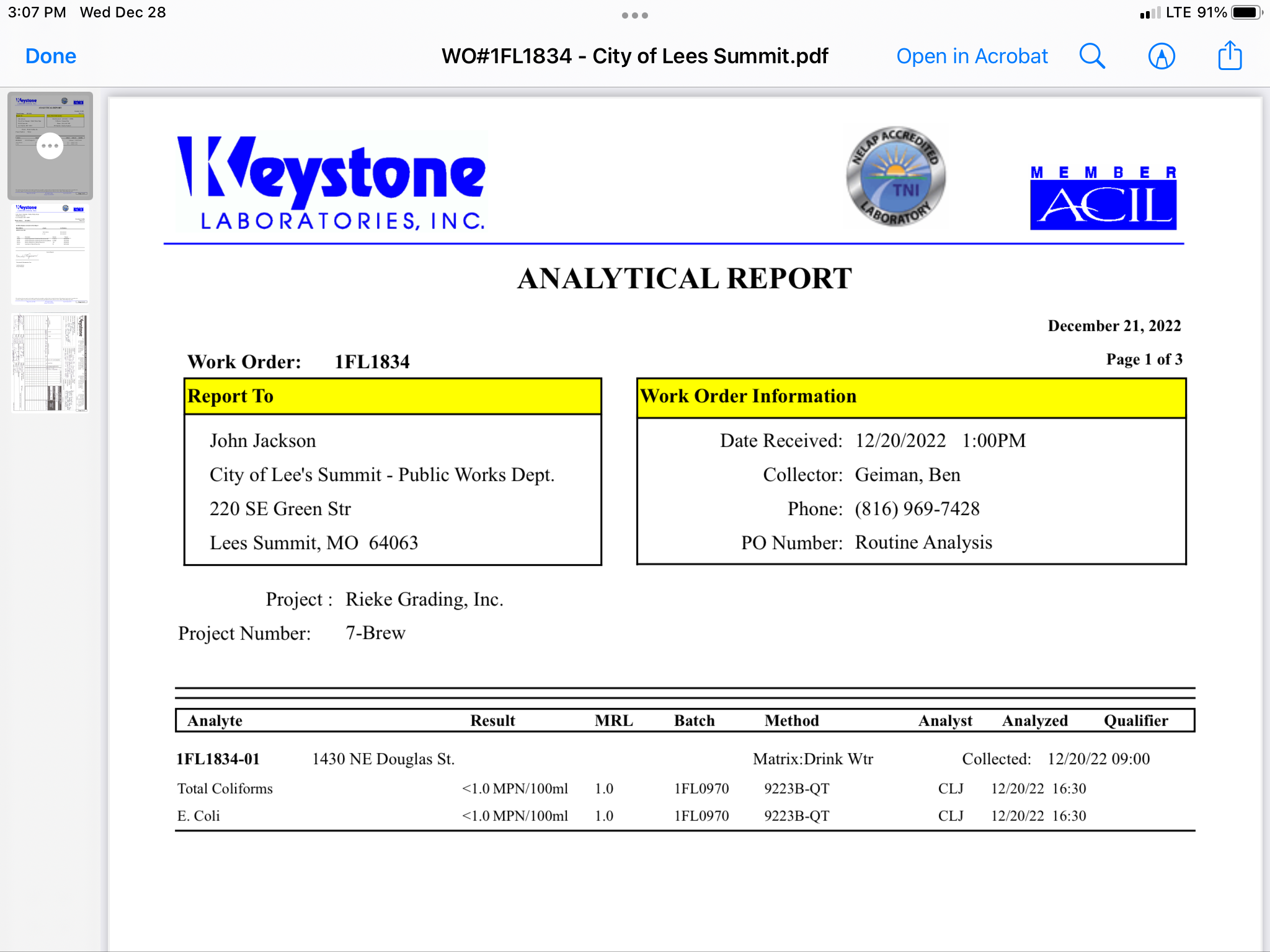

Water Line - Coliform Test 1 Passed 12/28/2022
Misc
Informational
12/28/2022
12/28/22 Wednesday JMJ ( Reike) First bacterial test passed last week.
Water Line - Construction Inspection Partial 12/29/2022
Misc
Informational
12/20/2022
12/05/22 Monday JMJ Contractor still searching for 1” tap off the main, 1” water main was laid last week to building. 12/14/22 Wednesday JMJ Contractor installing hydrant that was required by the City of Lee’s Summit so, domestic and irrigation taps can be made. 12/15/22 Thursday JMJ Contractor installed 6” water line & hydrant with back blocks behind 90 deg bend & hydrant schedule to be poured later today. 12/16/22 Friday JMJ Contractor continued work on completing the installed of 6” water line and hydrant. 12/19/22 Monday JMJ (Rieke Grading ) Contractor chlorinated water line on Sunday 12/18/22 2:00PM the de-chlorination will happen today at 2:00PM. De-chlorination started @ 3:10 PM . 12/20/22 Tuesday JMJ ( Rieke Grading ) Contractor took the first water sample today @ 9:00 AM. 12/29/22 Thursday JMJ Rieke Grading ) The City of Lee’s Summit made 1” domestic tap & 3/4” irrigation tap. Contractor set pits for both meters and ran the copper lines. The domestic meter was hook to the 1” line that’s was already laid from the building to the meter. The irrigation will line was ran out of the meter and stop and will be completed by the grounds crew at a later date.
Piers/Caissons Inspection - Commercial Failed 12/30/2022 (1:00) 12/30/2022 12/30/2022
Misc
Corrective Action Required
12/30/2022
-Not ready -Remove water, loose soil from piers -Secure all rebar to provide 3" clearance to earth -Complete all reinforcement for all piers
Piers/Caissons Inspection - Commercial Partial 1/5/2023 (8:00) 1/5/2023 01/05/2023
Misc
Informational
01/05/2023
-(8) Piers for canopy ok
Pavement-Stabilized Subgrade Partial 01/06/2023
Misc
Informational
12/12/2022
12/12/22 Monday JMJ Talked with contractor about get the approved Geogrid product before the began stabilization of subgrade. Contractor was able to installed approved product BOSTD RX1200 and MODOT 5. 01/06/23 Friday JMJ ( Reike Construction ) Contractor restarted installing Geogrid and covering it with rock for the project parking Lot.
Electrical Service Inspection Failed 1/9/2023 1/9/2023 01/09/2023
Misc
Corrective Action Required
01/09/2023
Site and equipment locked -Schedule when contractor will be on site to provide access to site and equipment for inspection
Pavement-Curb Construction Partial 1/11/2023 1/11/2023 01/11/2023
Misc
Informational
01/11/2023

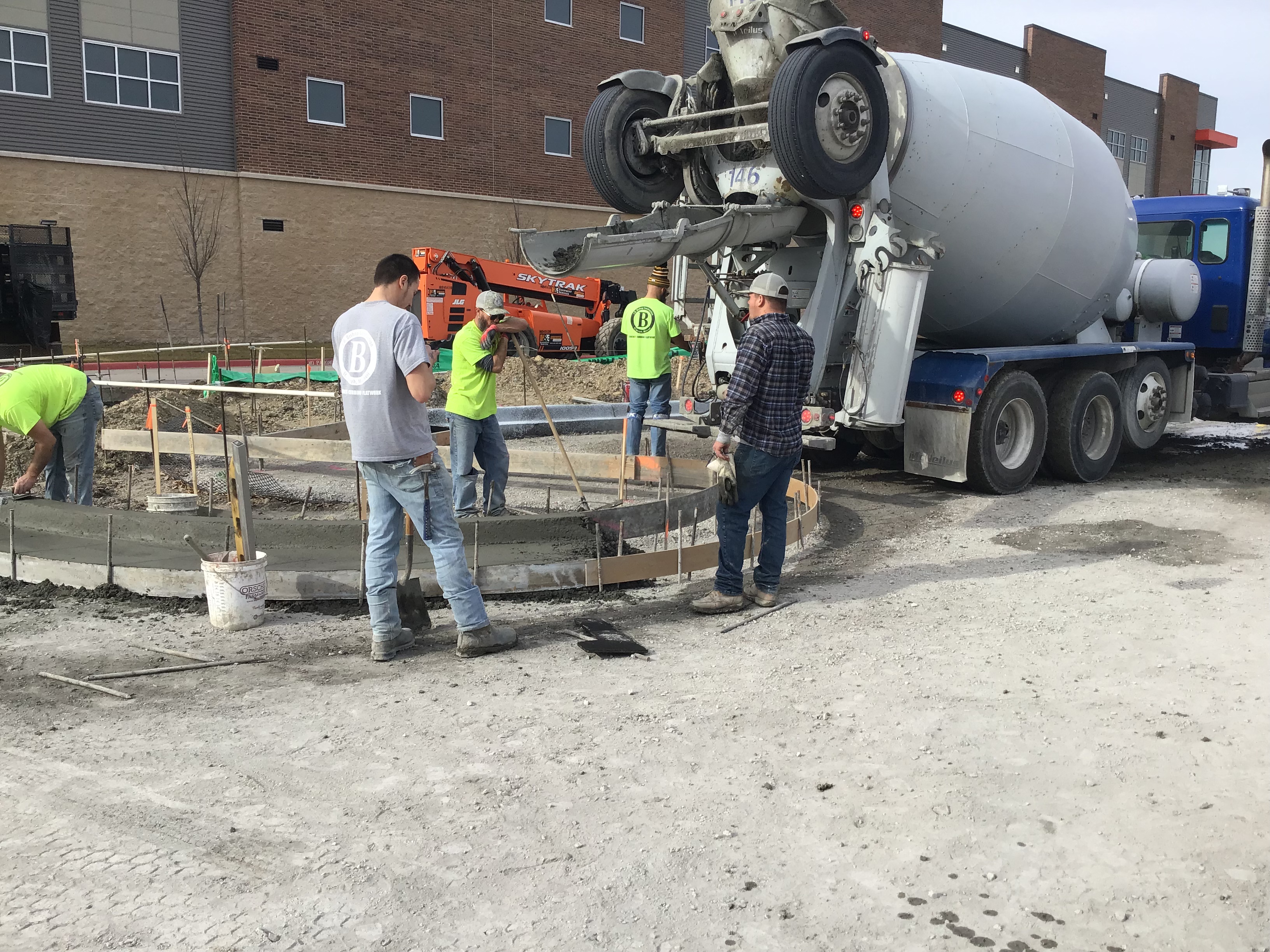

01/11/23 Wednesday JMJ ( JD Bishop ) Contractor poured approximately 38yards for concrete curbs.
Pavement-Curb Construction Partial 1/12/2023 1/12/2023 01/12/2023
Misc
Informational
01/11/2023
01/11/23 Wednesday JMJ ( JD Bishop ) Contractor poured approximately 38yards for concrete curbs. 01/12/23 Thursday JMJ ( JD Bishop ) Poured curbs and sidewalks near building. Advise contractor to cover curbs that were poured yesterday due to inclement weather conditions.
Pavement-Curb Construction Failed 1/12/2023 1/12/2023 01/12/2023
Misc
Corrective Action Required
01/12/2023
01/11/23 Wednesday JMJ ( JD Bishop ) Contractor poured approximately 38yards for concrete curbs. 01/12/23 Thursday JMJ ( JD Bishop ) Poured curbs and sidewalks near building. Advise contractor to cover curbs that were poured yesterday due to inclement weather conditions. ( Contractor nor subcontractor did not curbs cover with blankets. I talked with sub contractor about the covering of curbs no corrective action was performed.
Pavement-Stabilized Subgrade Partial 1/13/2023 1/13/2023 01/13/2023
Misc
Informational
01/06/2023
12/12/22 Monday JMJ Talked with contractor about get the approved Geogrid product before the began stabilization of subgrade. Contractor was able to installed approved product BOSTD RX1200 and MODOT 5. 01/06/23 Friday JMJ ( Reike Construction ) Contractor restarted installing Geogrid and covering it with rock for the project parking Lot. 01/13/23 Friday JMJ ( Reike Construction - Joe Brown ) Talked with the required temperature to lay asphalt next week.
Pavement-Curb Construction Partial 1/13/2023 1/13/2023 01/13/2023
Misc
Corrective Action Required
01/12/2023
01/11/23 Wednesday JMJ ( JD Bishop ) Contractor poured approximately 38yards for concrete curbs. 01/12/23 Thursday JMJ ( JD Bishop ) Poured curbs and sidewalks near building. Advise contractor to cover curbs that were poured yesterday due to inclement weather conditions. ( Contractor nor subcontractor did not curbs cover with blankets. I talked with sub contractor about the covering of curbs no corrective action was performed. 01/13/23 Friday JMJ (GC Rieke Grading (816) 985-9501 - Joe Brown, Sub Contractor JD Bishop ) Talked with contractor about how the curb were not blanketed after being notified that the drop in temperature required curbs to be covered. The developer needs to be aware that they are totally liable for the possible failure of curbs done by contractors.
Sidewalk Inspection Partial 1/17/2023 1/17/2023 01/17/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Rieke Construction & Sub for Concrete ) Contractor form sidewalks & drive approaches for concrete pour. I talked with Sub for concrete and informed him of specification for the drive approaches & sidewalks KCMMB 4K Concrete Mix.
Erosion Control Inspection Partial 1/18/2023 1/18/2023 01/18/2023
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control passed inspection.
Electrical Service Inspection Failed 1/19/2023 1/19/2023 01/19/2023
Misc
Corrective Action Required
01/09/2023
**Provide revised plan for the service. The plan shows 600 amp service **Current service configuration deficiencies: -Provide min 4/0 copper servide conductors for 225 amp breakers -Need access to water grounding inside building. Each 225 amp service disconnect must be grounded to water with grounding electrode conductor (GEC) to water sized per 250.66 based on the size of the service conductor. #2 copper GEC is required for 4/0 cu service conductor. -Grounding electrode conductors shall be continuous per 250.64(C) or with irreversible splice -Compliance with 250.24(A) or (A)(4)-Inside each service disconnect, connect the grounding electrode conductor to the grounded bus bar (either left or right) that the service grounded conductor is connected to; or install conductor jumper from the equipment grounding bus bar where the GEC is connected to, to the service grounded bus bar
Electrical Service Inspection Failed 1/25/2023 1/25/2023 01/25/2023
Misc
Corrective Action Required
01/19/2023
**Provide revised plan for the service. The plan shows 600 amp service **Current service configuration deficiencies: -Need access to water grounding inside building. Each 225 amp service disconnect must be grounded to water with grounding electrode conductor (GEC) to water sized per 250.66 based on the size of the service conductor. #2 copper GEC is required for 4/0 cu service conductor. **If only one common grounding electrode conductor to water is installed to ground both service disconnects, then the common GEC size shall be no smaller than 1/0 copper. Each separate GEC to each service disconnect shall be connected to the common GEC with irreversible splice -Compliance with 250.24(A) or (A)(4)-Inside each service disconnect, connect the grounding electrode conductor to the grounded bus bar (either left or right) that the service grounded conductor is connected to; or install conductor jumper from the equipment grounding bus bar where the GEC is connected to, to the service grounded bus bar
Erosion Control Inspection Partial 1/26/2023 1/26/2023 01/26/2023
Misc
Informational
01/26/2023
01/26/23 Thursday JMJ Erosion was working properly.
Electrical Service Inspection Passed 1/30/2023 1/30/2023 01/30/2023
Misc
Resolved
01/30/2023
**Provide revised plan for the service. The plan shows 600 amp service **Current service configuration deficiencies: -Need access to water grounding inside building. Each 225 amp service disconnect must be grounded to water with grounding electrode conductor (GEC) to water sized per 250.66 based on the size of the service conductor. #2 copper GEC is required for 4/0 cu service conductor. **If only one common grounding electrode conductor to water is installed to ground both service disconnects, then the common GEC size shall be no smaller than 1/0 copper. Each separate GEC to each service disconnect shall be connected to the common GEC with irreversible splice -Compliance with 250.24(A) or (A)(4)-Inside each service disconnect, connect the grounding electrode conductor to the grounded bus bar (either left or right) that the service grounded conductor is connected to; or install conductor jumper from the equipment grounding bus bar where the GEC is connected to, to the service grounded bus bar
Sidewalk Inspection Partial 2/6/2023 2/6/2023 02/06/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Rieke Construction & Sub for Concrete ) Contractor form sidewalks & drive approaches for concrete pour. I talked with Sub for concrete and informed him of specification for the drive approaches & sidewalks KCMMB 4K Concrete Mix. 02/06/23 Monday JMJ ( Johnson County Heavy Contracting ) Contractor poured sidewalks, ADA, south approach, and around building. KCMMB 4K mix was used today on public portion of project. Contractor will continue to pour parking lot and drive area for project. 04/05/23 Wednesday JMJ ( Johnson County Heavy Contracting ) Contractor poured the public sidewalk and ADA ramp connecting to the driveway approach.
Pavement-Curb Construction Partial 2/7/2023 2/7/2023 02/07/2023
Misc
Corrective Action Required
01/13/2023
01/11/23 Wednesday JMJ ( JD Bishop ) Contractor poured approximately 38yards for concrete curbs. 01/12/23 Thursday JMJ ( JD Bishop ) Poured curbs and sidewalks near building. Advise contractor to cover curbs that were poured yesterday due to inclement weather conditions. ( Contractor nor subcontractor did not curbs cover with blankets. I talked with sub contractor about the covering of curbs no corrective action was performed. 01/13/23 Friday JMJ (GC Rieke Grading (816) 985-9501 - Joe Brown, Sub Contractor JD Bishop ) Talked with contractor about how the curb were not blanketed after being notified that the drop in temperature required curbs to be covered. The developer needs to be aware that they are totally liable for the possible failure of curbs done by contractors.
Misc
Informational
02/07/2023
02/07/23 Tuesday ( Johnson County Heavy Contracting LLC ) Contractor poured floor and land pad of dumpster area.
Erosion Control Inspection Partial 2/14/2023 2/14/2023 02/14/2023
Misc
Informational
01/18/2023
01/18/23 Wednesday JMJ Erosion control passed inspection. 02/14/23 Tuesday JMJ Contractor has a small amount of clean-up at the North entrance.
Site Visit Partial 3/10/2023 3/10/2023 03/10/2023
Misc
Informational
12/01/2022
09/22/22 Thursday JMJ Contractor was working on footing for building, grading of siter has continued. 10/05/22 Wednesday JMJ Contractor continued to work on site and building footing. 10/25/22 Tuesday JMJ Contractor installed dumpster walls and balliard poles. 11/30/22 Wednesday JMJ Talked with contractor about using Geogrid in areas that asphalt was going to be laid. I instructed the contractor to review the approved list of Geogrid. Contractor mentioned to survey crew that they will probably have to install hydrant. 12/01/22 Thursday JMJ Contractor worked on backfilling excavation (sanitary). 03/10/23 Friday JMJ Contractor pump out water off work site to dry-out subgrade for surface installment.
Driveway Inspection Partial 4/5/2023 4/5/2023 04/05/2023
Misc
Informational
04/05/2023
04/05/23 Wednesday JMJ ( Johnson City Heavy Contracting ) Contractor is poring the driveway and approach at the Northern entrance. Mix for the approach is the KCMMBGPS4K44 mix.
Sidewalk Inspection Partial 4/6/2023 4/6/2023 04/06/2023
Misc
Informational
02/06/2023
01/17/23 Tuesday JMJ ( Rieke Construction & Sub for Concrete ) Contractor form sidewalks & drive approaches for concrete pour. I talked with Sub for concrete and informed him of specification for the drive approaches & sidewalks KCMMB 4K Concrete Mix. 02/06/23 Monday JMJ ( Johnson County Heavy Contracting ) Contractor poured sidewalks, ADA, south approach, and around building. KCMMB 4K mix was used today on public portion of project. Contractor will continue to pour parking lot and drive area for project. 04/06/23 Thursday JMJ ( Johnson County Heavy Contracting ) Contractor poured North driveway entrance and approach, sidewalk & ADA ramp & South sidewalk & ADA ramp was completed. Inspector made the contractor spray more white cure.
Pavement-Proof Roll Passed 4/10/2023 4/10/2023 04/10/2023
Misc
Informational
04/10/2023
04/10/23 Monday JMJ ( Rieke Construction ) Proof roll passed and contractor will install asphalt portion of driveway.
Pavement-Aggregate Base Partial 4/13/2023 4/13/2023 04/13/2023
Misc
Informational
04/13/2023
04/13/23 Thursday JMJ ( Little Joe's Asphalt ) Contractor began laying installing APWA type 2 rec base asphalt at 7:30 AM. The last load for base asphalt arrived at 11:37 AM.
Pavement-Surface Partial 1/17/2023 1/17/2023 04/13/2023
Misc
Informational
01/17/2023
01/17/23 Tuesday JMJ ( Reike Construction ) Contractor continue to
Misc
Informational
04/13/2023
04/13/23 Thursday JMJ ( Little Joe's Asphalt ) Contractor started laying the surface asphalt APWA Type 5 recycle 12:20PM.
Footing Inspection - Commercial Passed 05/04/2023
Misc
Resolved
05/04/2023
- TRASH ENCLOSURE FOOTING OK TO POUR - 12/21/22-HAVE REVISED FOUNDATION PLAN ON SITE FOR THE 4 CANOPY PIERS; CLEAN OUT ALL LOOSE DIRT AND TRASH; INSTALL 3 #3 TIES AT UPPER END OF PIERS; MIN 3" CLEARANCE OF REBAR FROM SOIL
Piers/Caissons Inspection - Commercial Passed 05/04/2023
Misc
Resolved
05/04/2023
-Not ready -Remove water, loose soil from piers -Secure all rebar to provide 3" clearance to earth -Complete all reinforcement for all piers
Occupancy Inspection - Codes Commercial Failed 5/4/2023 5/4/2023 05/04/2023
Misc
Corrective Action Required
05/04/2023
-Complete corrections for all other departments -Secure drainage piping and cut off 1" above flood level rim at mop sink -Provide panel schedules and label panels -Provide ASSE 1022 or 1024 backflow devices at all beverage machines -Provide permanent address at Douglas side of building *OK to stock and train-not approved for public
Occupancy Inspection - Engineering Partial 5/4/2023 5/4/2023 05/04/2023
Misc
Corrective Action Required
05/05/2023
1. ADA sidewalks on both sides of North entrance need to be repaired. 2. Water valve box needs to be cut to grade. 3. Sodding at the top of the hill on Eastside of building along the public sidewalk. Bushes and mulch will be installed Northside wrapping around East of building going to the South of building.
Occupancy Inspection - Planning Temporary C of O 5/4/2023 05/04/2023
Miscellaneous Correction
Corrective Action Required
05/04/2023
The assigned planner for this project is Hector Soto was not available at the time of inspection. A preliminary inspection was performed and there no planning associated items that would prohibit the issuance of a Temporary Certificate of Occupancy. A complete planning inspection will be performed and comment on outstanding items will be provided as soon as possible.
Occupancy Inspection - Water Utilities Passed 5/4/2023 05/04/2023
Occupancy Inspection - Codes Commercial Ready for Temp CO 5/8/2023 5/8/2023 05/08/2023
Misc
Corrective Action Required
05/04/2023
-Complete corrections for all other departments *Codes complete
Occupancy Inspection - Planning Passed 5/10/2023 05/10/2023
Miscellaneous Correction
Corrective Action Required
05/04/2023
The assigned planner for this project is Hector Soto was not available at the time of inspection. A preliminary inspection was performed and there no planning associated items that would prohibit the issuance of a Temporary Certificate of Occupancy. A complete planning inspection will be performed and comment on outstanding items will be provided as soon as possible.
Occupancy Inspection - Fire Passed 5/8/2023 5/8/2023 05/26/2023
Occupancy Inspection - Engineering Passed 05/31/2023
Miscellaneous Correction
Resolved
05/31/2023
1. ADA sidewalks on both sides of North entrance need to be repaired. 2. Water valve box needs to be cut to grade. 3. Sodding at the top of the hill on Eastside of building along the public sidewalk. Bushes and mulch will be installed Northside wrapping around East of building going to the South of building.
Occupancy Inspection - Codes Commercial Full C of O 05/31/2023
Misc
Resolved
05/31/2023
-Complete corrections for all other departments *Codes complete
Documents & Images
Date Uploaded File Type Document Name
05/23/2022 Application Form Commercial Permit Application (Executed)
05/23/2022 Engineer Report/Study 2022-02-25 Geotechnical Engineering Report B21G4397
05/23/2022 Plans 220519 - 7 Brew - Lee's Summit, MO - Permit Set
06/07/2022 Letter DS P/R Corrections Document
06/23/2022 Letter 7 Brew - Lee's Summit, MO - Response Letter
06/23/2022 Plans 220622 - 7 Brew - Lee's Summit, MO - Permit Set
07/06/2022 Letter 220706 - 7 Brew - Lee's Summit, MO - ADD 002 Narrative
07/06/2022 Plans 220706 - 7 Brew - Lee's Summit, MO - Combined Set
07/21/2022 Letter Fire Building Plan Review
08/05/2022 Letter Jackson County Health Approval
08/08/2022 Approved Plans Approved 7 Brew FDP Civil and Elevations
08/11/2022 Receipt Receipt for transaction:2022-006625
08/24/2022 Receipt Receipt for transaction:2022-006970
09/07/2022 Letter DS Building Permit
09/07/2022 Approved Plans approved - 7 Brew - Lee's Summit, MO - Combined Set
09/20/2022 Letter INSPECTION SUMMARY
09/22/2022 Letter INSPECTION SUMMARY
09/23/2022 Letter INSPECTION SUMMARY
10/05/2022 Letter INSPECTION SUMMARY
10/10/2022 Letter INSPECTION SUMMARY
10/25/2022 Silt Fencing
10/25/2022 Letter INSPECTION SUMMARY
10/25/2022 Letter INSPECTION SUMMARY
11/16/2022 Letter INSPECTION SUMMARY
11/17/2022 Letter INSPECTION SUMMARY

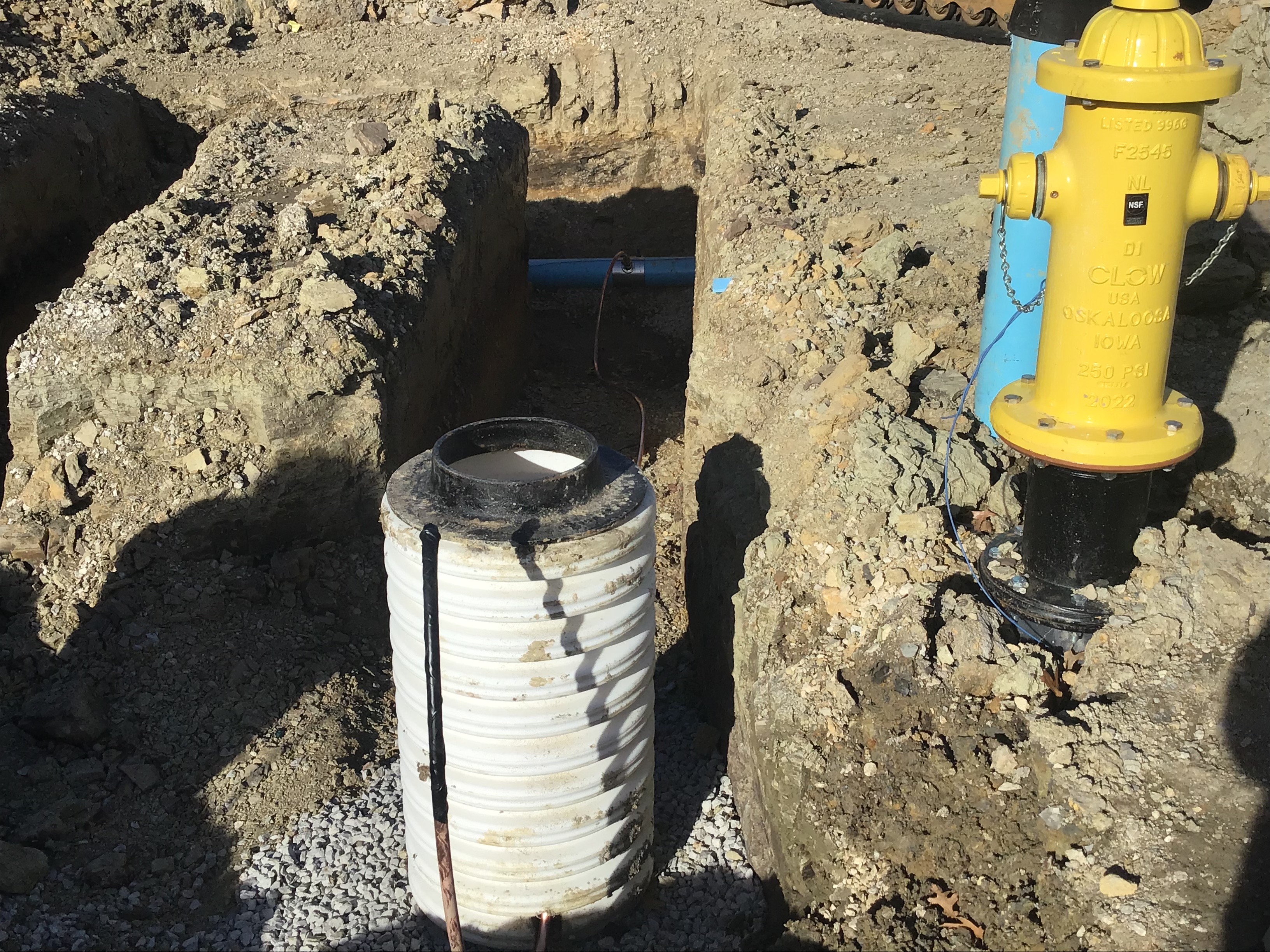

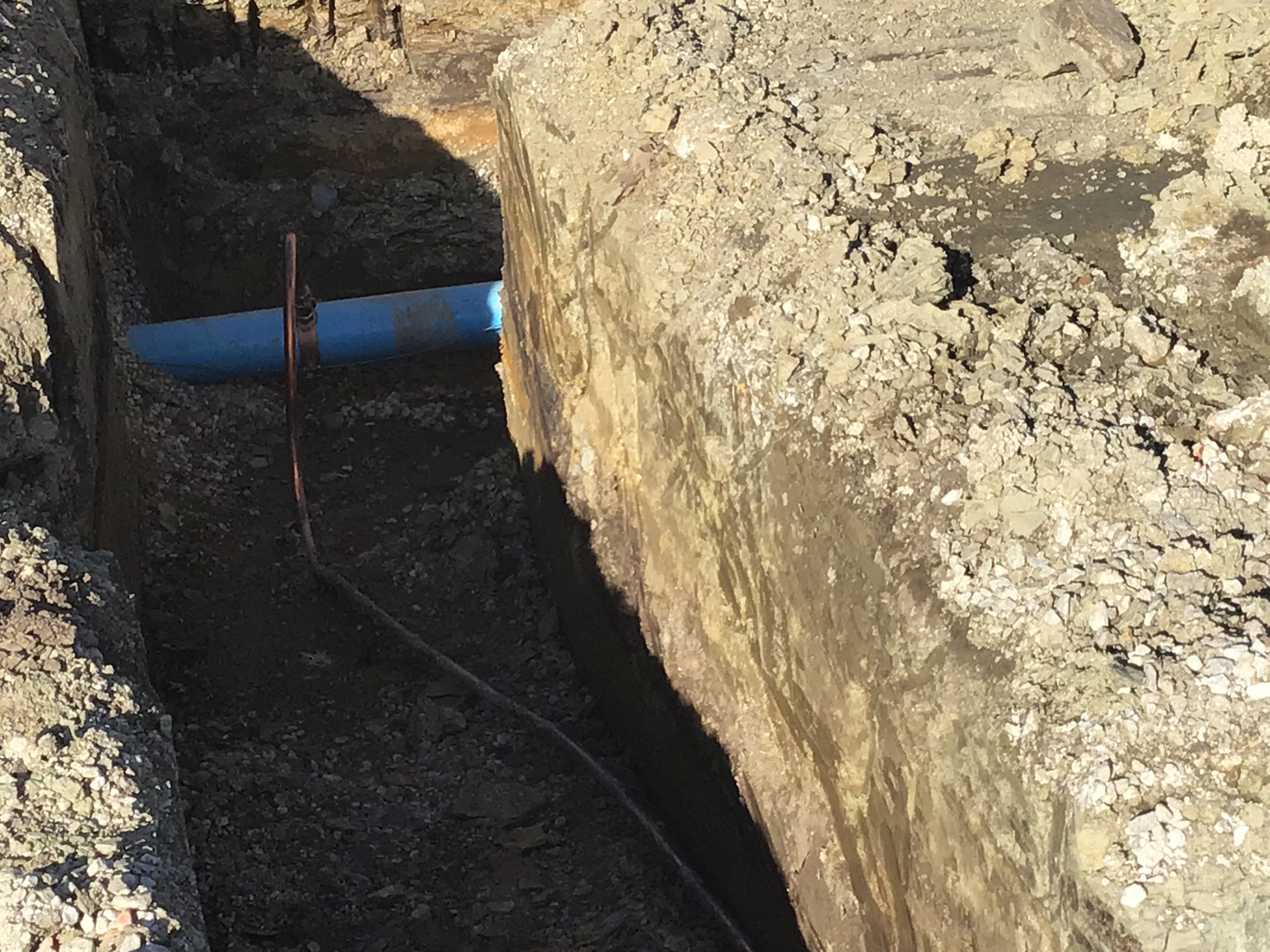

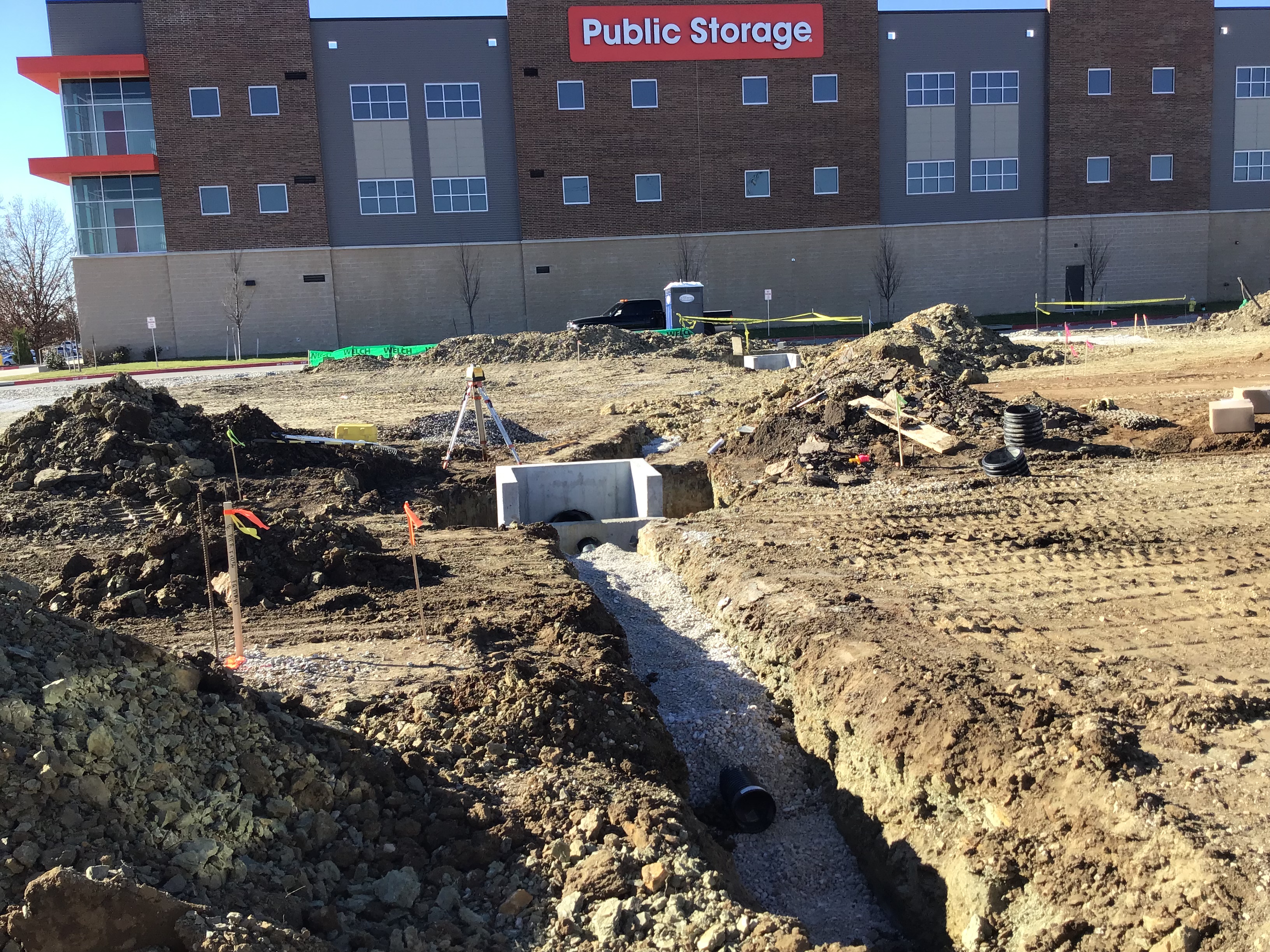

11/18/2022 12” HDPE Storm Pipe Running From A-2 to A-1
11/18/2022 Letter INSPECTION SUMMARY
11/21/2022 A-1 Storm Box & 20’ of 6” HPDE Storm Pipe
11/21/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/22/2022 Letter INSPECTION SUMMARY
11/29/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
11/30/2022 Letter INSPECTION SUMMARY
12/01/2022 Letter INSPECTION SUMMARY
12/01/2022 Letter INSPECTION SUMMARY
12/02/2022 Letter INSPECTION SUMMARY
12/03/2022 Westside of Building ( Drive-Through ) 1
12/03/2022 Westside of Building ( Drive-Through ) 2
12/03/2022 Far Eastside of Project where Curbs will be Installed 1
12/03/2022 Far Eastside of Project where Curbs will be Installed 2
12/03/2022 Letter INSPECTION SUMMARY
12/03/2022 Southside of Building Surface Area of Subgrade 1
12/03/2022 Southside of Building Surface Area of Subgrade 2
12/03/2022 Letter INSPECTION SUMMARY
12/03/2022 Northside of Drive-Through Water Saturated
12/03/2022 Westside of Drive-Through Rolled In
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/05/2022 Letter INSPECTION SUMMARY
12/06/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/12/2022 Letter INSPECTION SUMMARY
12/14/2022 Letter INSPECTION SUMMARY
12/15/2022 Fire Hydrant
12/15/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
12/21/2022 221221- Lee Summit Rear Canopy Footing
12/21/2022 221221-Typical Canopy Drain Lines at Footings
12/22/2022 Letter INSPECTION SUMMARY
12/28/2022 First Pass Bacterial Test
12/28/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/28/2022 Second Passing Bacterial Sample
12/29/2022 Domestic & Irrigation Meter Pits
12/29/2022 Irrigation Line and Meter Pit
12/29/2022 Domestic 1” Line
12/29/2022 Letter INSPECTION SUMMARY
12/30/2022 Letter INSPECTION SUMMARY
01/05/2023 Letter INSPECTION SUMMARY
01/06/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY

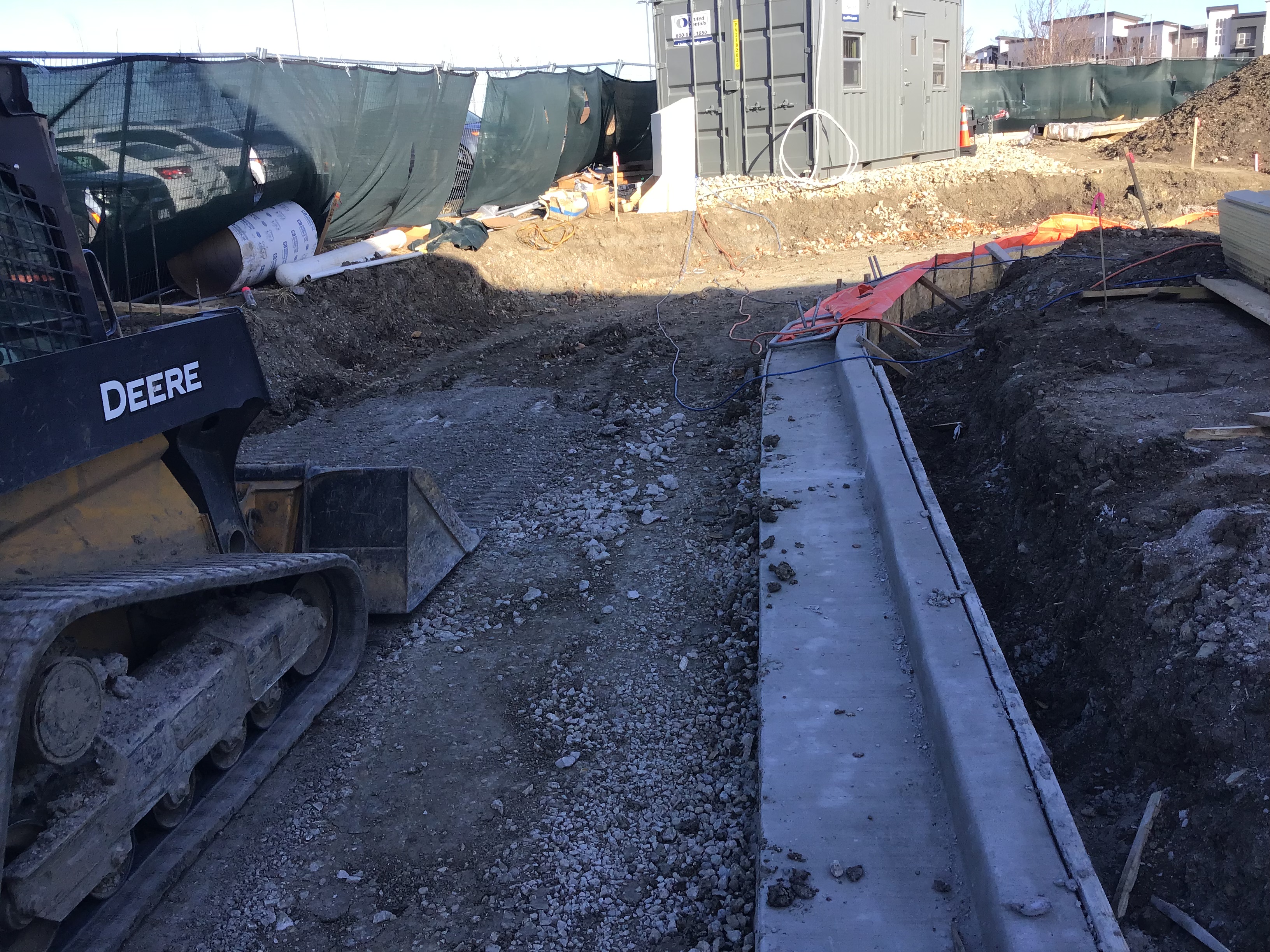

01/11/2023 Curbs 1
01/11/2023 Curbs 2
01/11/2023 Letter INSPECTION SUMMARY
01/12/2023 Letter INSPECTION SUMMARY
01/12/2023 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/18/2023 Letter INSPECTION SUMMARY
01/19/2023 Letter INSPECTION SUMMARY
01/25/2023 Drawing E1_2
01/25/2023 Approved Plans approved - E1_2
01/25/2023 Letter INSPECTION SUMMARY
01/26/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/06/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/07/2023 Letter INSPECTION SUMMARY
02/08/2023 Concrete Approach
02/08/2023 Sidewalk
02/14/2023 Letter INSPECTION SUMMARY
03/10/2023 Letter INSPECTION SUMMARY
04/04/2023 4397GP-C401
04/05/2023 Letter INSPECTION SUMMARY
04/05/2023 7 Brews Sidewalk ADA Driveway
04/05/2023 Letter INSPECTION SUMMARY
04/06/2023 7 Brews Sidewalk ADA at South Entrance
04/06/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/13/2023 7Brews First Asphalt Base Ticket
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 7Brews Last Ticket for Asphalt Base
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 7Brews Surface Asphalt First Last Ticket
04/13/2023 Letter INSPECTION SUMMARY
04/13/2023 Letter INSPECTION SUMMARY
04/24/2023 20230424095411
05/03/2023 Receipt Receipt for transaction:2023-002705
05/03/2023 Receipt Receipt for transaction:2023-002750
05/04/2023 Letter INSPECTION SUMMARY
05/04/2023 Letter INSPECTION SUMMARY
05/04/2023 Jackson County Environmental Health Division
05/04/2023 Letter INSPECTION SUMMARY
05/04/2023 Letter INSPECTION SUMMARY
05/04/2023 Letter INSPECTION SUMMARY
05/08/2023 Letter INSPECTION SUMMARY
05/08/2023 Certificate/License Codes Temporary Certificate of Occupancy
05/08/2023 Receipt Receipt for transaction:2023-002917
05/31/2023 Letter INSPECTION SUMMARY
05/31/2023 Letter Field Certificate of Occupancy
05/31/2023 Letter Codes Final Certificate of Occupancy
01/18/2024 Codes Temporary Certificate of Occupancy180
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
