Summary
PRCOM20212244
Building Permit - Commercial
Certificate of Occupancy
MCCAFFREE FINANCIAL CORP
NEW COMMERCIAL
NEW BANK WITH DRIVE-THRU ATM UNDER DETACHED CANOPY
05/04/2021
08/12/2021
11/07/2021
11/22/2022
Locations
Contacts
TURNER CONSTRUCTION COMPANY, Address:1220 WASHINGTON STE 1000, Phone:(816) 283-0555
CITY WIDE SHEET METAL, INC, Address:2820 G ROE LN, Phone:(913) 871-7464
STACO ELECTRIC CONSTRUCTION COMPANY INC, Address:11030 HICKMAN MILLS DR, Phone:(816) 765-7112
KANSAS CITY MECHANICAL INC, Address:6822 KANSAS AVE, Phone:(913) 334-1101
Core States, Address:6500 Chippewa St, Suite 200, Phone:(314) 270-5203
rpropp@tcco.com
MCCAFFREE FINANCIAL CORP, Address:4701 W 110TH ST
Reviews
Review Type Outcome Est. Completion Date Completed
Final Development Plan Review Approved 08/02/2021
Mike Weisenborn
Building Plan Review Rejected 06/24/2021 06/18/2021
Joe Frogge
Licensed Contractors Rejected 06/24/2021 06/18/2021
Joe Frogge
LC - MEP Subs
Corrective Action Required
06/17/2021

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 6/18/21 - acknowledged in letter.
LC - General Contractor
Corrective Action Required
06/17/2021

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the name of the licensed general contractor and an email address for the on-site contact. 6/18/21 - acknowledged in letter.
Fire Plan Review Approved 06/24/2021 06/17/2021
Michael Weissenbach
Address numbers required
Resolved
06/17/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Resolved
06/17/2021

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Informational Purposes) A Knox Box is not required. If you choose to mount one an order can be placed at knoxbox.com.
Illumination required
Resolved
06/17/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required)(Verified At Inspection) Provide exterior emergency lighting at the exits.
Fire Plan Review Approved with Conditions 05/18/2021 05/10/2021
Michael Weissenbach
Address numbers required
Corrective Action Required
05/10/2021

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). (Verified At Inspection)
Knox box required
Corrective Action Required
05/10/2021

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. (Informational Purposes) A Knox Box is not required. If you choose to mount one an order can be placed at knoxbox.com.
Illumination required
Corrective Action Required
05/10/2021

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied. (Action Required)(Verified At Inspection) Provide exterior emergency lighting at the exits.
Building Plan Review Rejected 05/18/2021 05/07/2021
Joe Frogge
Final Development Plan
Corrective Action Required
05/06/2021

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
Misc
Corrective Action Required
05/06/2021

A License Tax application completed by the contractor must be submitted to the City of Lee's Summit, Codes Administration Department, and any applicable License Tax paid prior to issuing a building permit. Action required: Comment is for informational purposes.
SEC - CPTED
Corrective Action Required
05/06/2021

Code of Ordinances Section 8.330. CPTED Review Requirement. All development applications shall be subject to CPTED review and recommendations. The application of CPTED concepts and strategies is site specific and the level of review shall be determined on a case by case basis. Some requests during development review will require mandatory compliance. Others will be strongly encouraged but compliance will be voluntary. Mandatory compliance elements will be addressed in Article 9 “Uses with Conditions”. Section 8.340. CPTED Uses Specified The following uses have been classified as “Uses with Conditions” per Article 9 of this Chapter, having been determined with a tendency toward an increased risk of crime,. Specific conditions for such uses are found in Article 9 and shall be required to be met prior to receiving any zoning approval, business license or approval to occupy any commercial space. 1. Bank/Financial Services 2. Bank Drive-Thru Facility 3. Check Cashing and Payday Loan Business 4. Convenience Store (C-Store) 5. Financial Services with Drive-up Window or Drive-Thru Facility 6. Pawn Shop 7. Title Loan Business, if performing on site cash transactions with $500 or more in cash on hand 8. Unattended self-serve gas pumps 9. Unsecured Loan Business 10. Other similar uses shall meet the same standards as the above Action required: Submit drawings or detailed report/spec to demonstrate compliance. A separate review for CPTED requirements must be performed. Permit will not be issued until CPTED review is approved.
IBC 1803.1 General - geotech
Corrective Action Required
05/07/2021

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf.
NEC Article 210.8 (B) Other than dwelling units GFCI
Corrective Action Required
05/07/2021

2017 NEC Article 210.8 (B) Other Than Dwelling Units. All 125-volt, single-phase, 15- and 20-ampere receptacles installed in the locations specified in 210.8(B)(1) through (10) shall have ground-fault circuit-interrupter protection for personnel. (1) Bathrooms (2) Kitchens (3) Rooftops (4) Outdoors (5) Sinks - where receptacles are installed within 6 feet of the outside edge of the sink. (6) Indoor wet locations (7) Locker rooms with associated showering facilities (8) Garages, service bays, and similar areas other than vehicle exhibition halls and showrooms. (9) Crawl spaces – at or below grade level. (10) Unfinished portions or areas of the basement not intended as habitable rooms. (refer to code for exceptions) Action required: Modify drawings to show that all receptacles within 6' of a sink will by GFCI protected. (ref: Janitor Closet 114)
Miscellaneous Correction
Corrective Action Required
05/07/2021

Unable to find reference to NG piping spec. Action required: Specify NG pipe materials.
Licensed Contractors Rejected 05/18/2021 05/06/2021
Joe Frogge
Fees
Paid Fees Amount Paid Owing Date Paid
Valuation Fee for New Commercial $1,800.00 $1,800.00 Paid 08/12/2021
8331507-Sewer Connection Fee $210.00 $210.00 Paid 08/12/2021
Commercial Excise Tax Fee $33,090.00 $33,090.00 Paid 08/12/2021
Right of Way Permit Fee $80.00 $80.00 Paid 08/12/2021
Site Grading Fee $4,738.25 $4,738.25 Paid 08/12/2021
Water Insp Fee $650.58 $650.58 Paid 08/12/2021
Paved Surface Inspection Fee $1,505.25 $1,505.25 Paid 08/12/2021
Sanitary Sewer Insp Fees $650.58 $650.58 Paid 08/12/2021
Temporary Occupancy Fee $50.00 $50.00 Paid 09/21/2022
Temporary Occupancy Fee $50.00 $50.00 Paid 10/24/2022
Temporary Occupancy Fee $50.00 $50.00 Paid 11/18/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

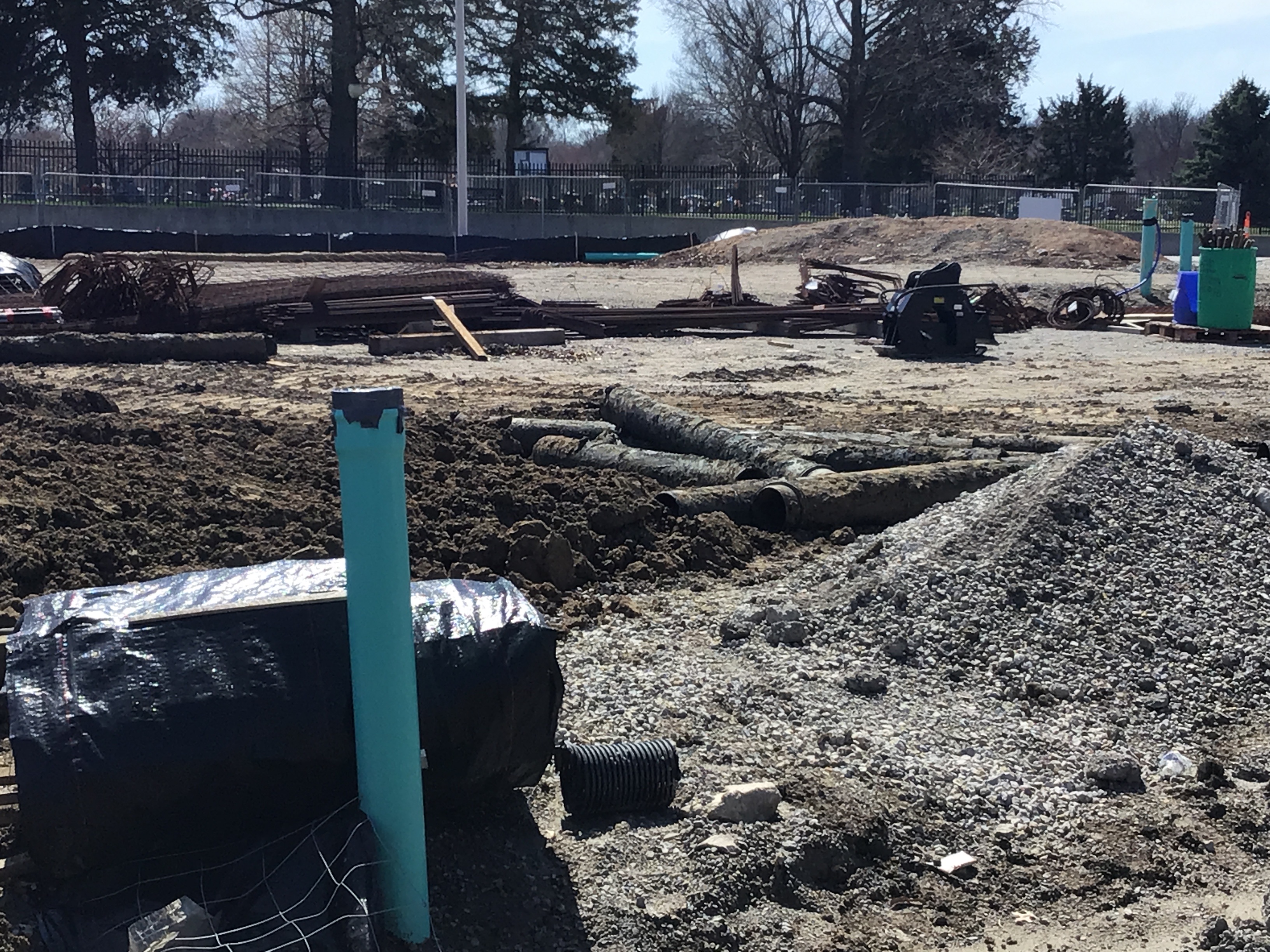

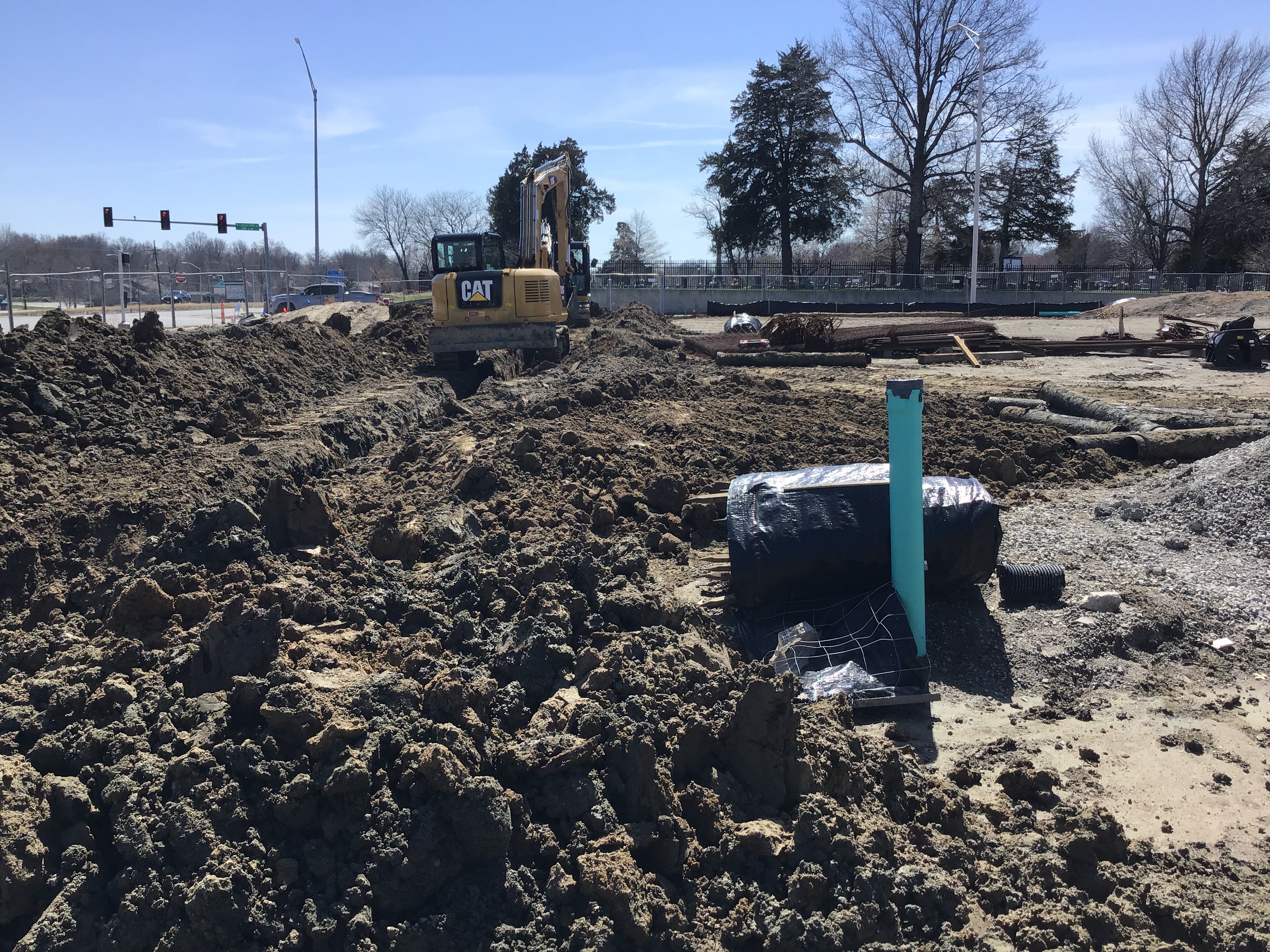

Grading/Excavation/Fill Inspection Partial 10/8/2021 10/08/2021

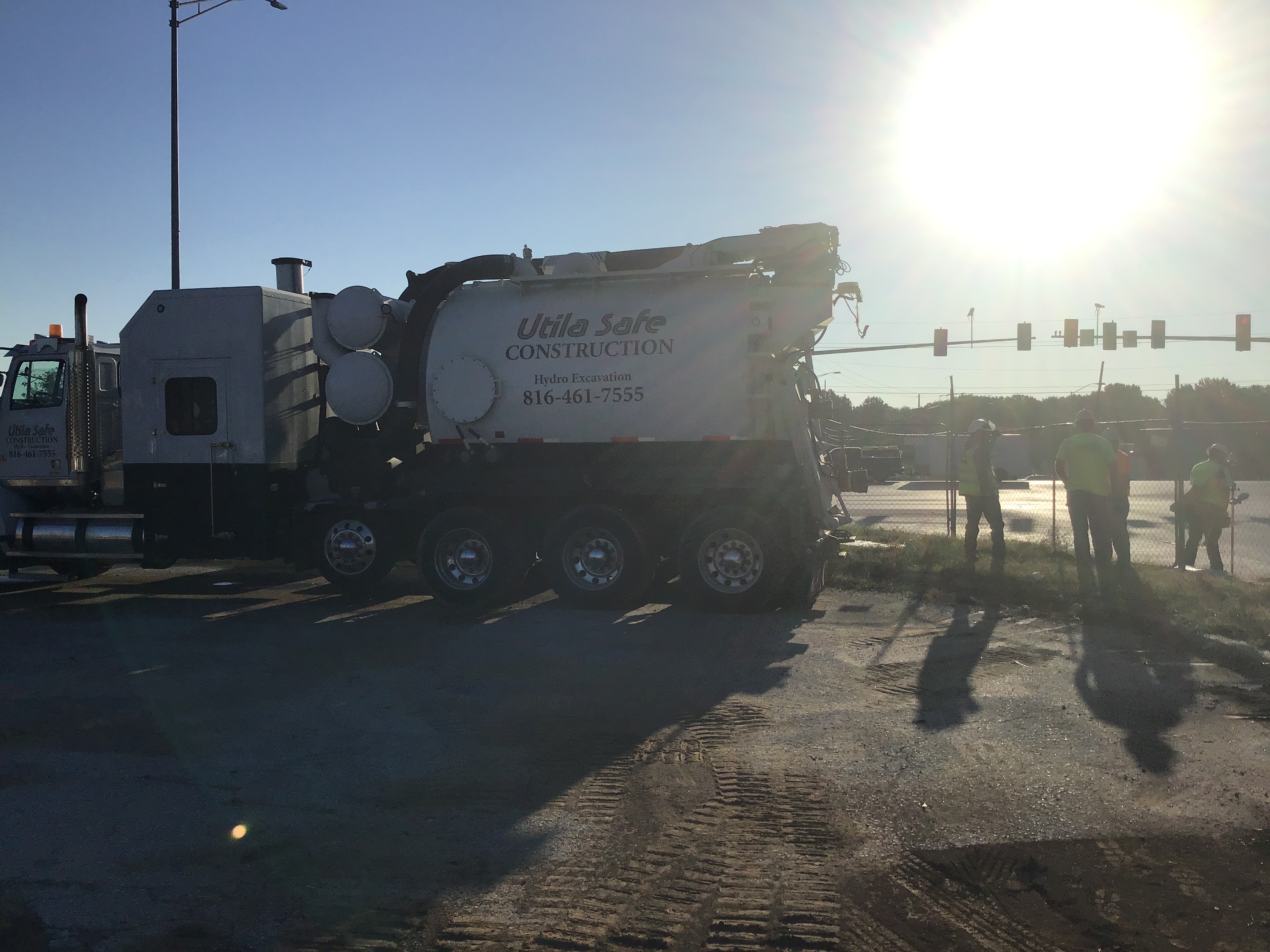

Misc
Informational
10/08/2021
10/08/21 Friday Grading & excavating of site for Construction.

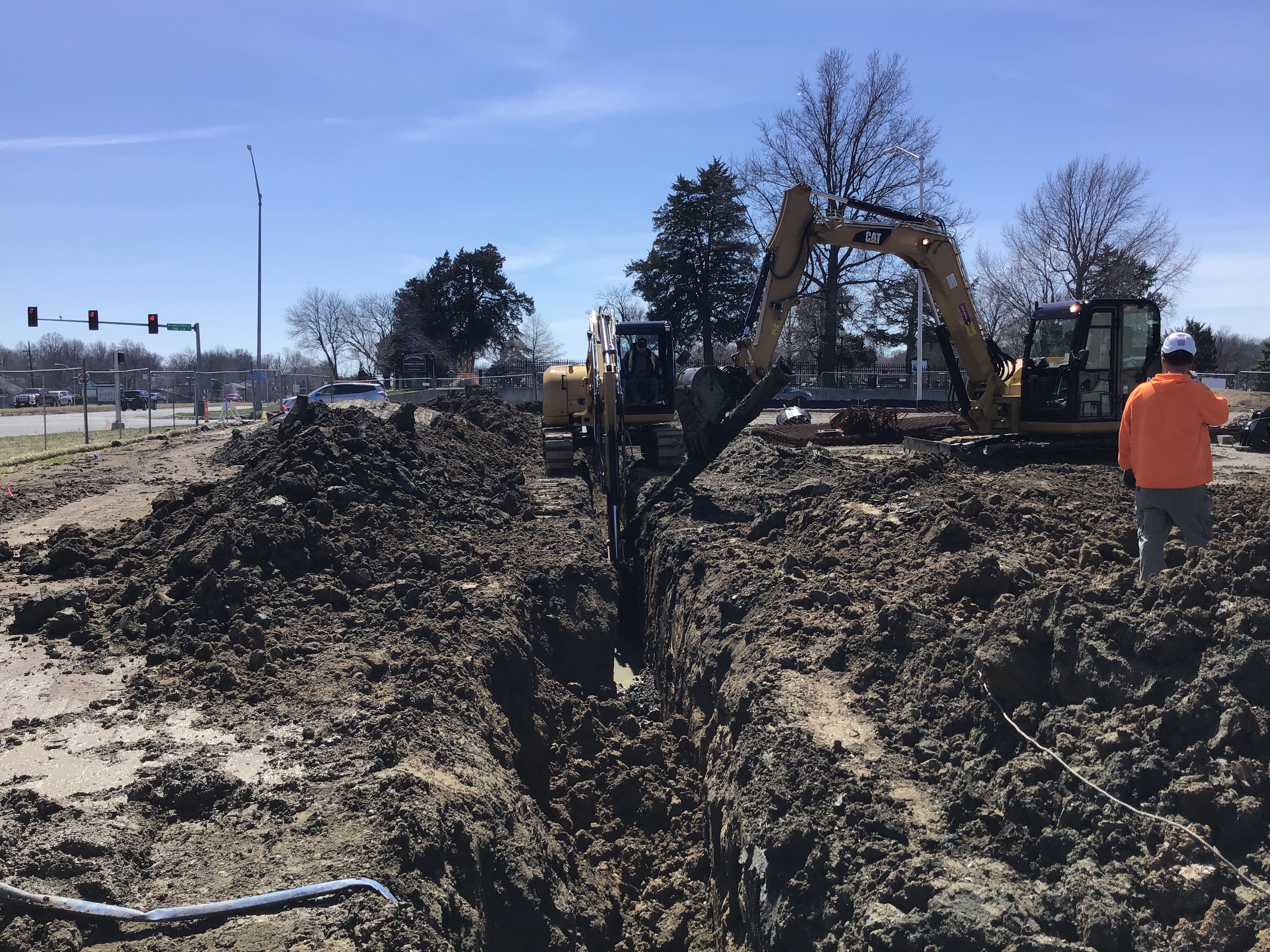

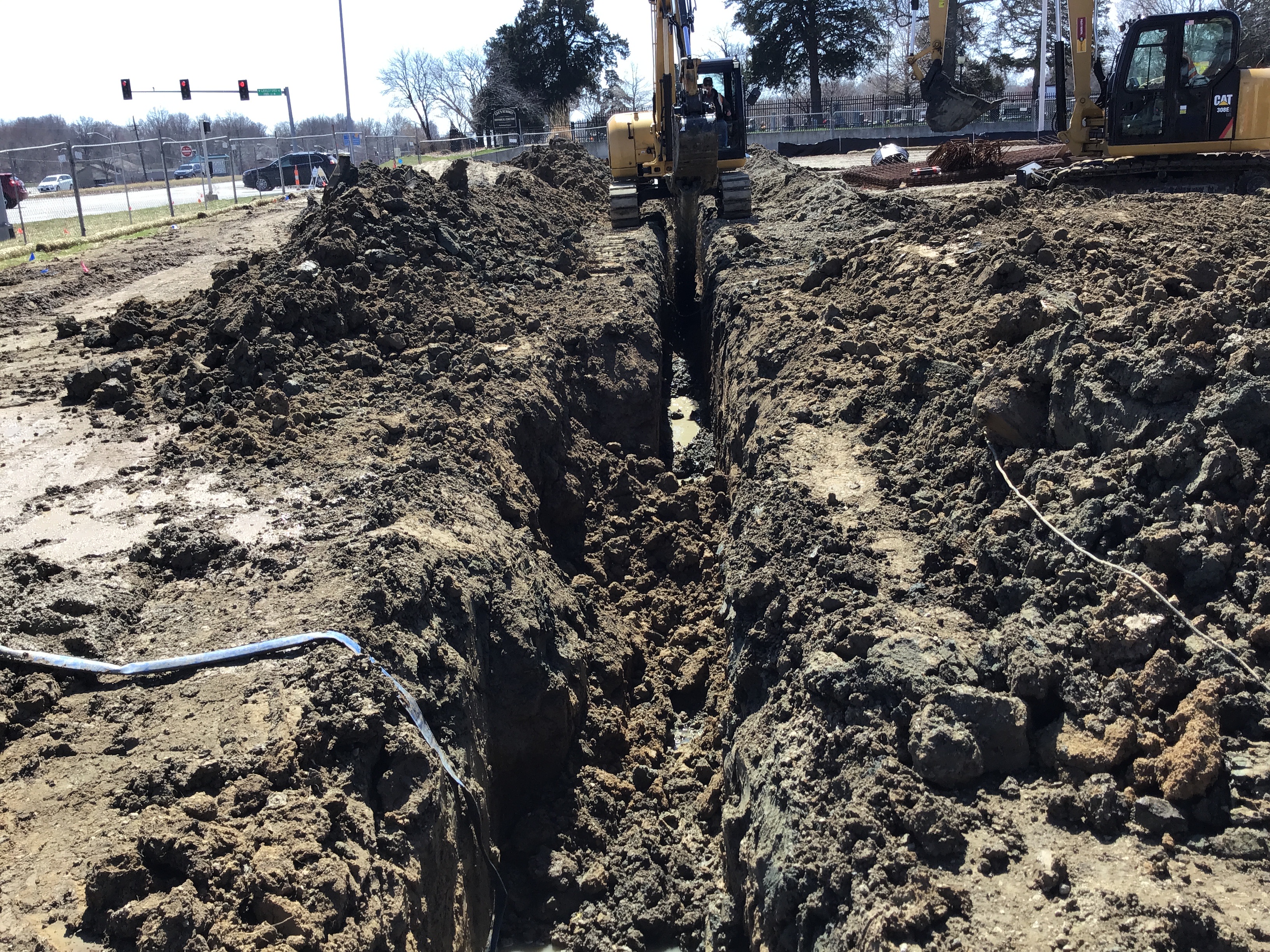

Sewer Service Inspection Partial 10/12/2021 10/12/2021
Misc
Informational
10/12/2021
Misc
Informational
10/12/2021

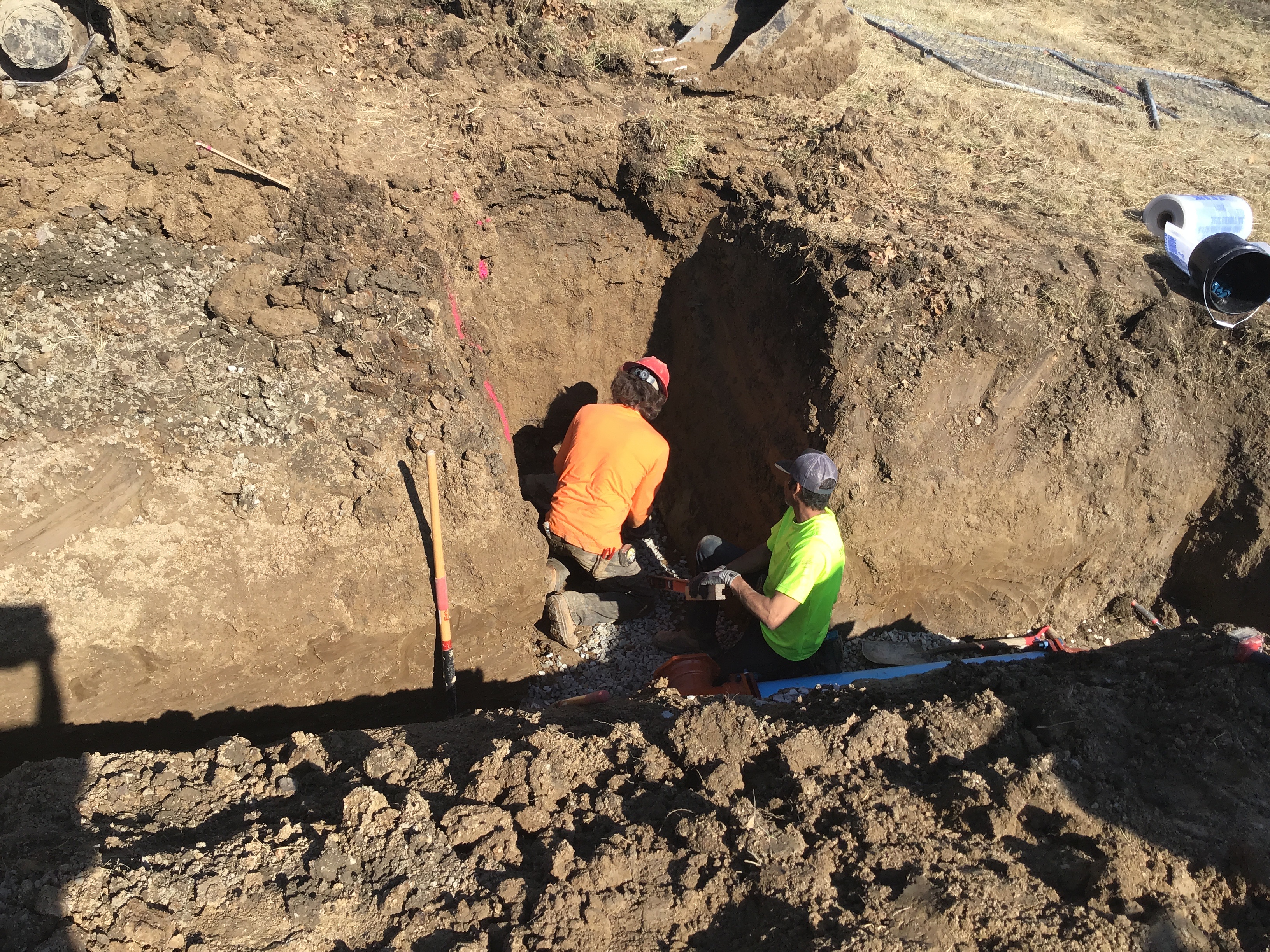

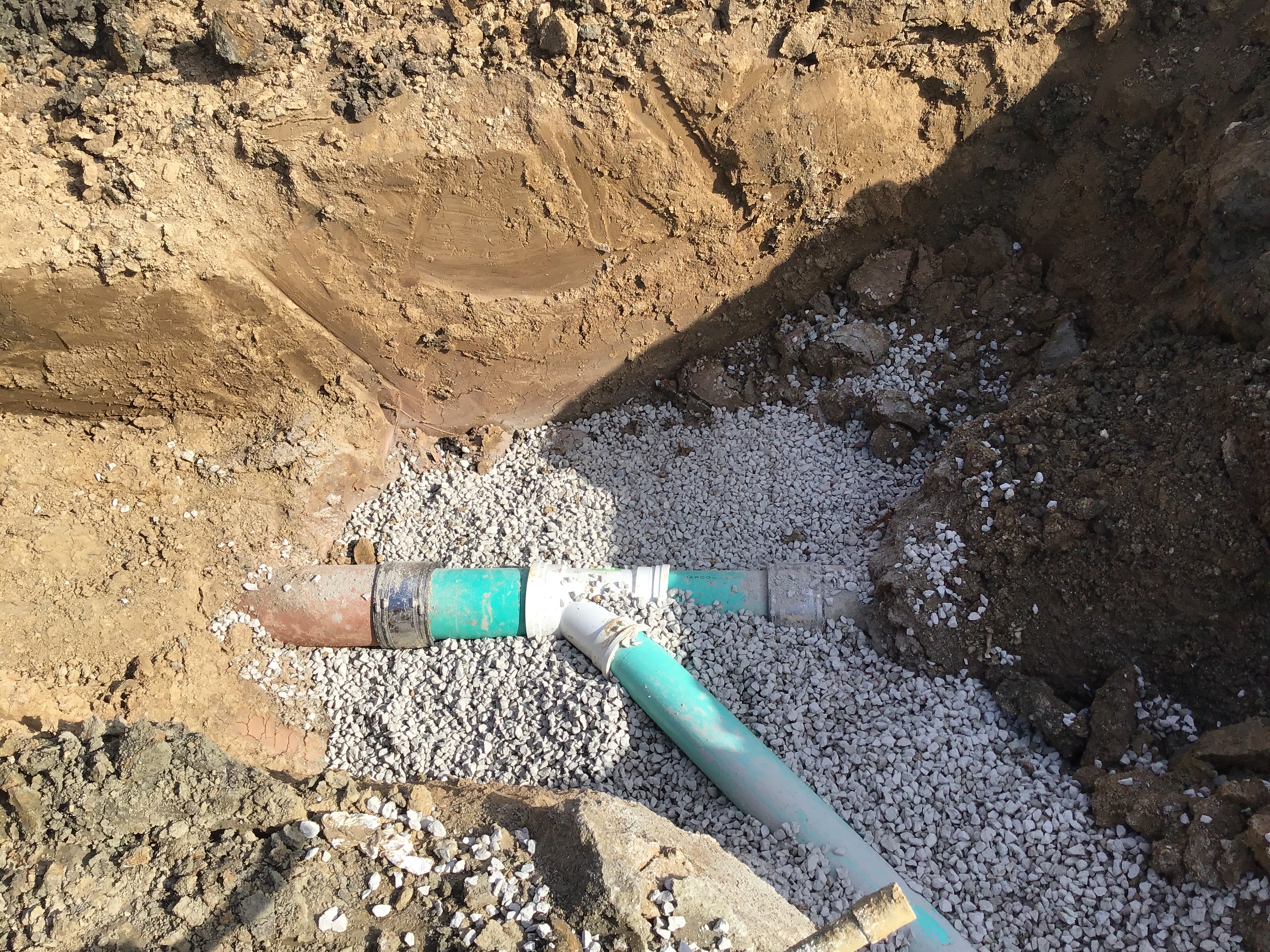

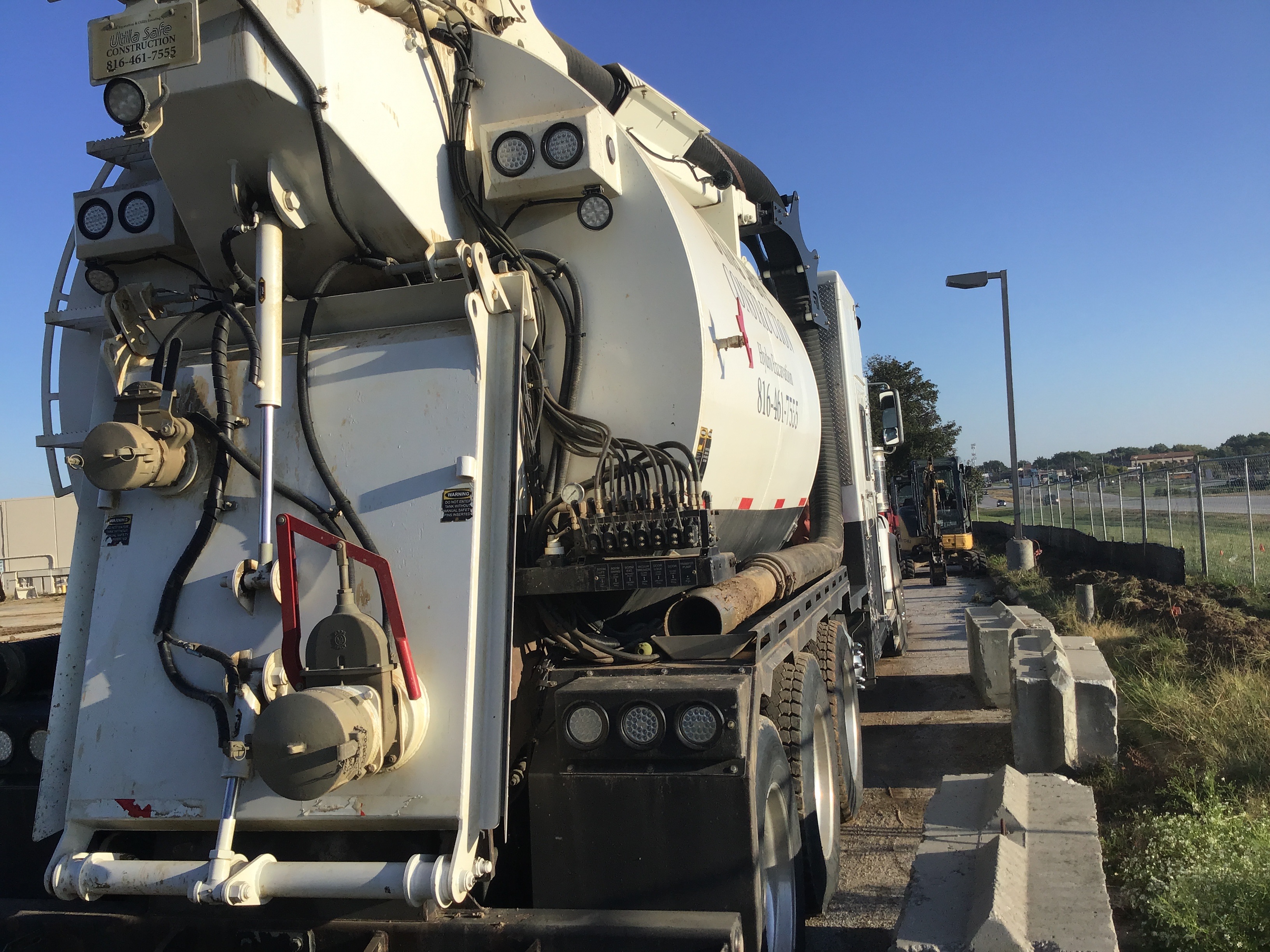

10/12/21 Tuesday (Kissick Const.) Sanitary tie-in with 8”X6” wye & 2 hardback Fernco on the Existing “8 clay pipe. 11’ to the 6” wye and 7’ more to the 6” 22.5 bends. Contractor change the lateral from the 6” wye from a 22.5 to a 45deg bend. From the 22.5 to the next wye is approximately 90’ of 26 SDR. Clean-out directly from the Wye and the lateral line going to the building. See project plans page C10.

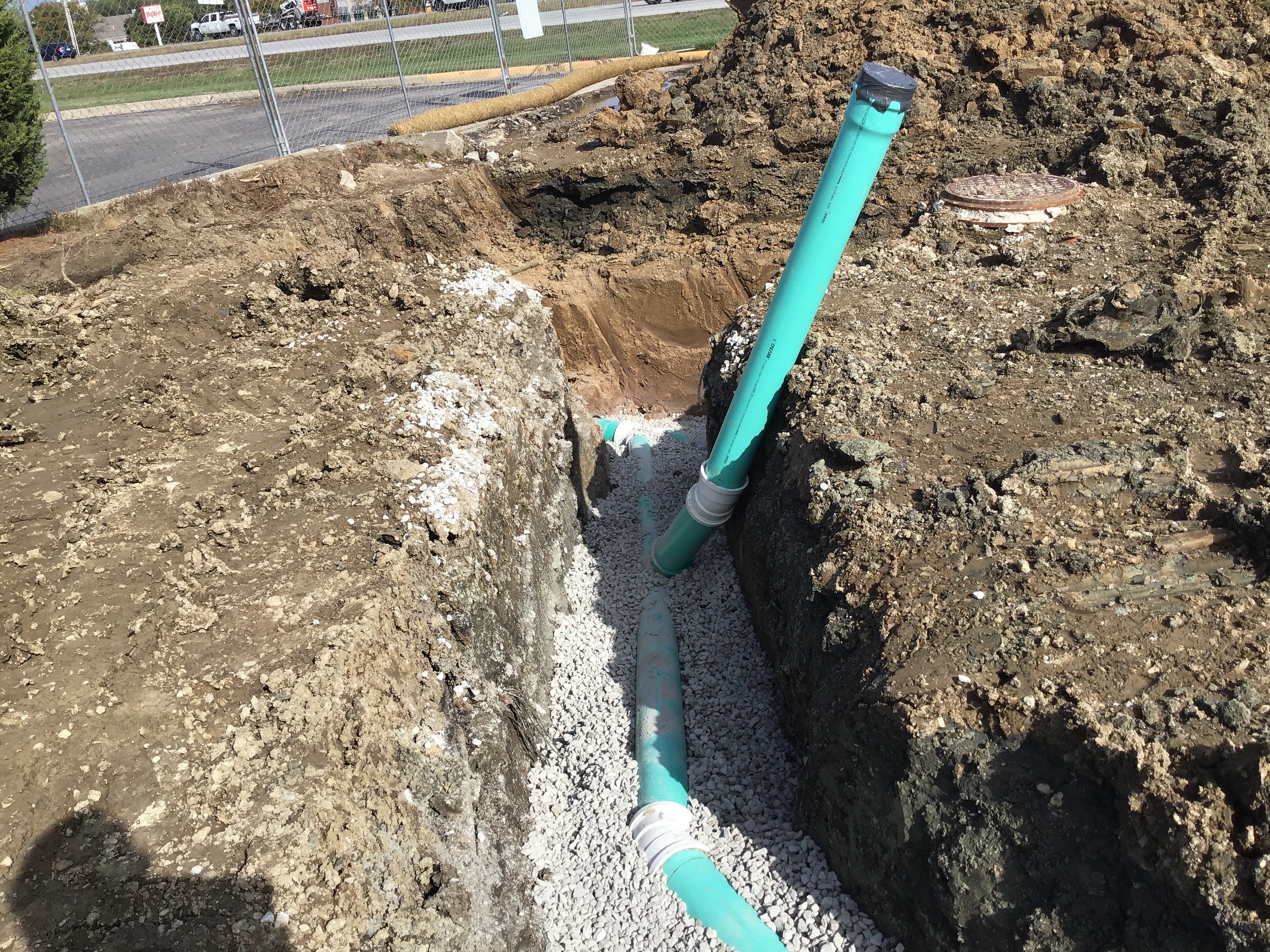

Water Service Inspection Partial 10/14/2021 10/14/2021
Misc
Informational
10/14/2021

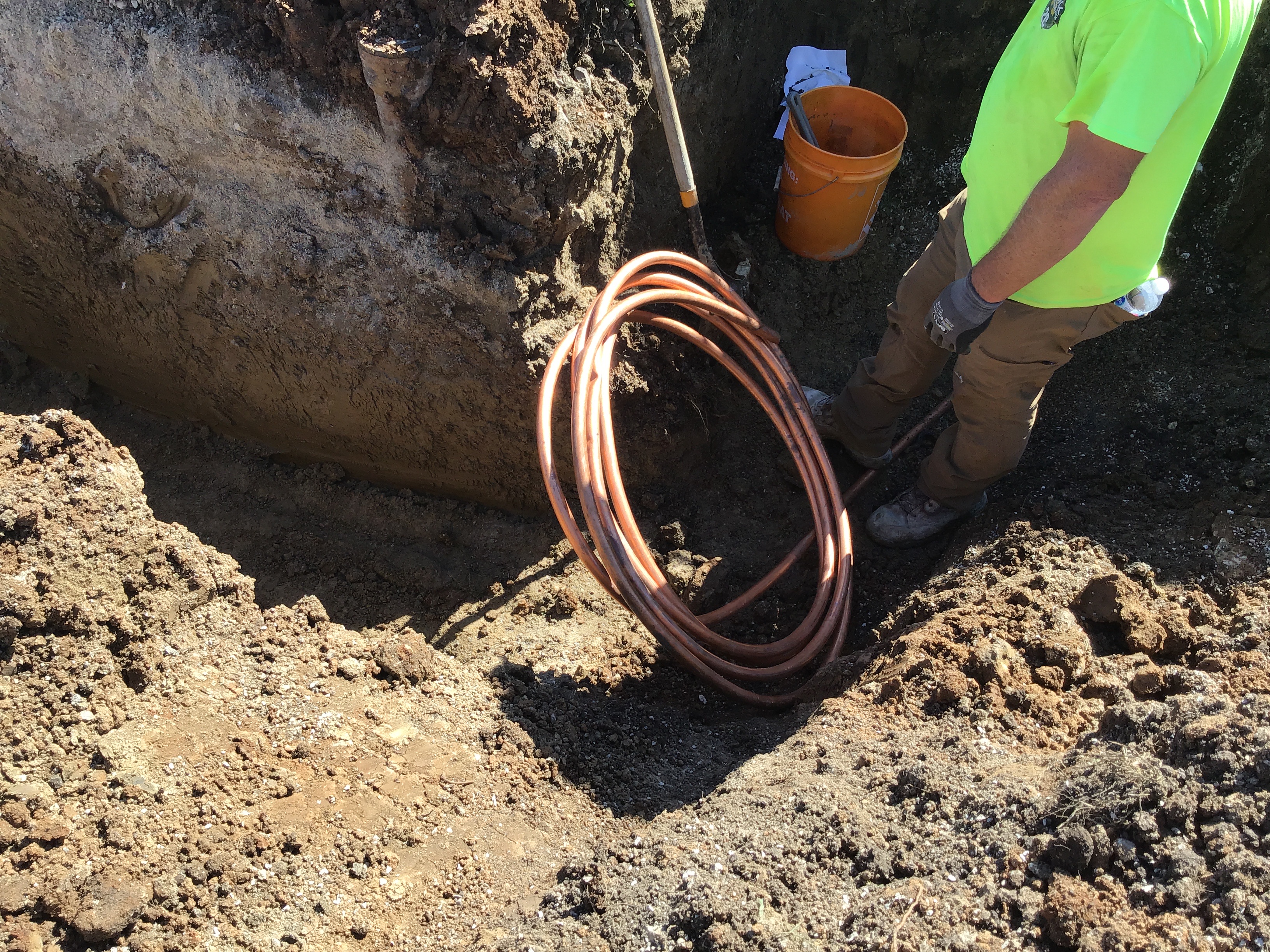

10/14/21 Thursday (Kissick) Turner Co. is the general Contractor installed the 1” water service line 10’ of copper and approximately 160’ of 1” blue poly PVC for domestic water service.
Site Visit Partial 10/15/2021 10/15/2021
Misc
Informational
10/15/2021
10/15/21 Friday Met with contractor and City Lee’s Summit Project Engineer and a Water Supervisor. The topic of discussion is the location of valves and the relocation of the existing 6” water main from the foundation boundaries of the building. 10/20/21 Wednesday (Kissick Const.) Contractor installing (LVC) for the building pad. 10/21/21 Thursday (Kissick Const. Subcontractor) Turner is the General Contractor continued to install (LVC) for parking lot. 10/26/21 Tuesday (Kissick Const.) Monday 10/25/21 Contractor continued to grade site with (LVC) Low Volume Content. Engineer are still working to come up with a solution to resolve the Issue with the existing 6” water location. 02/04/22 Friday Work onsite should resume soon after underground utilities project plans were revised. 02/22/22 Tuesday No work onsite, it appears that construction materials were placed on site. Erosion control measure are still in place. Waiting for approval of project changes. 02/24/22 Thursday No work. 03/14/22 Monday Met with contractor and Water Dept. onsite to plan for water line replacement (Steve Robbins, Jeremy Young , & a Water Engineer were on site). Contractor locating existing water main and further review of water shut and installation of new main. 03/15/22 Tuesday (Wiedemann, INC.) Contractor continued work to prepare for water installation. 03/30/22 Wednesday No work. 03/31/22 Thursday No work.
Pavement-Stabilized Subgrade Partial 10/19/2021 10/19/2021
Misc
Informational
10/19/2021

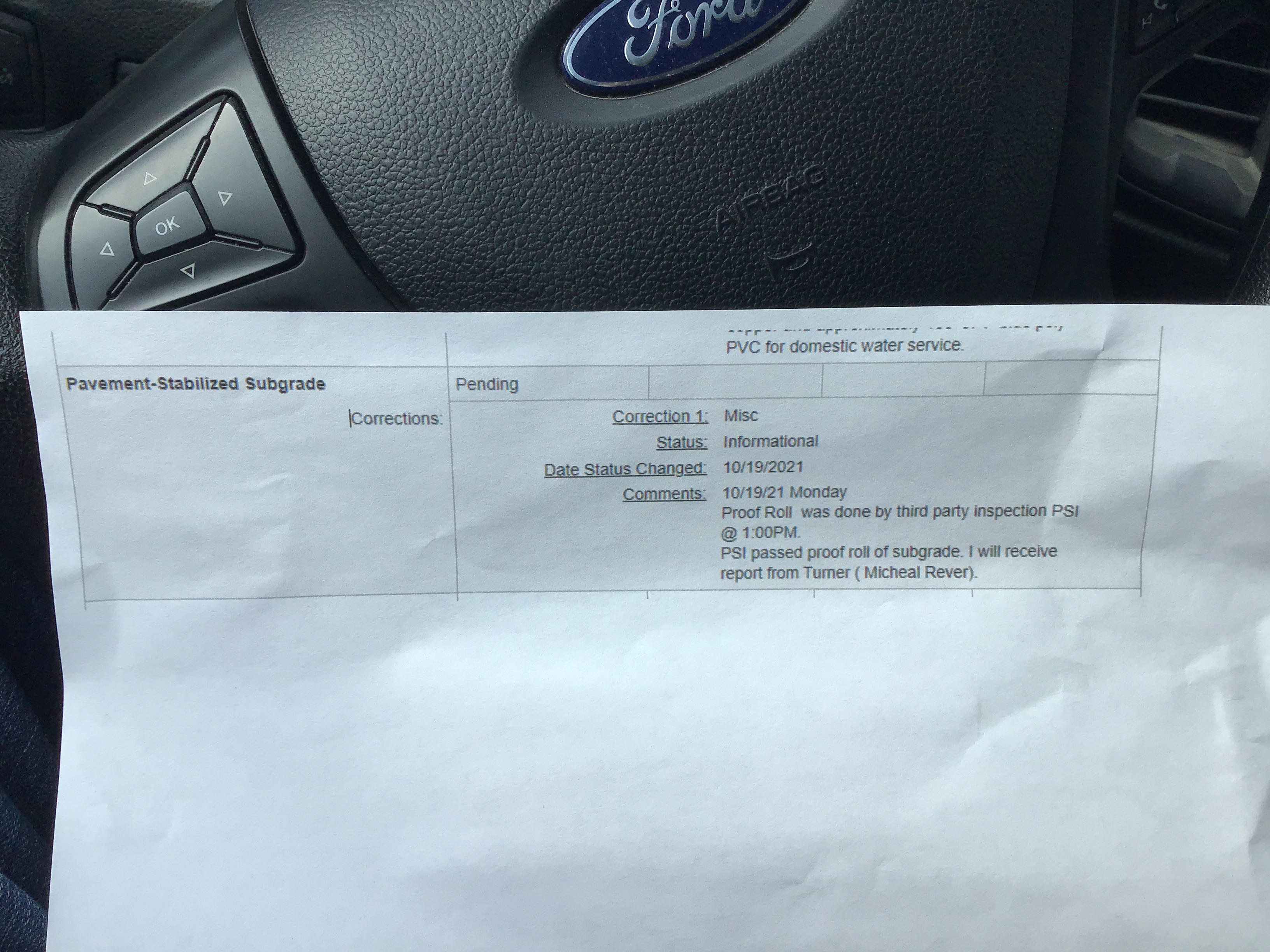

10/19/21 Monday Proof Roll was done by third party inspection PSI @ 1:00PM. PSI passed proof roll of subgrade. I will receive report from Turner ( Micheal Rever). 10/22/21 Friday Contractor continued to install (LVC) to stabilize subgrade.

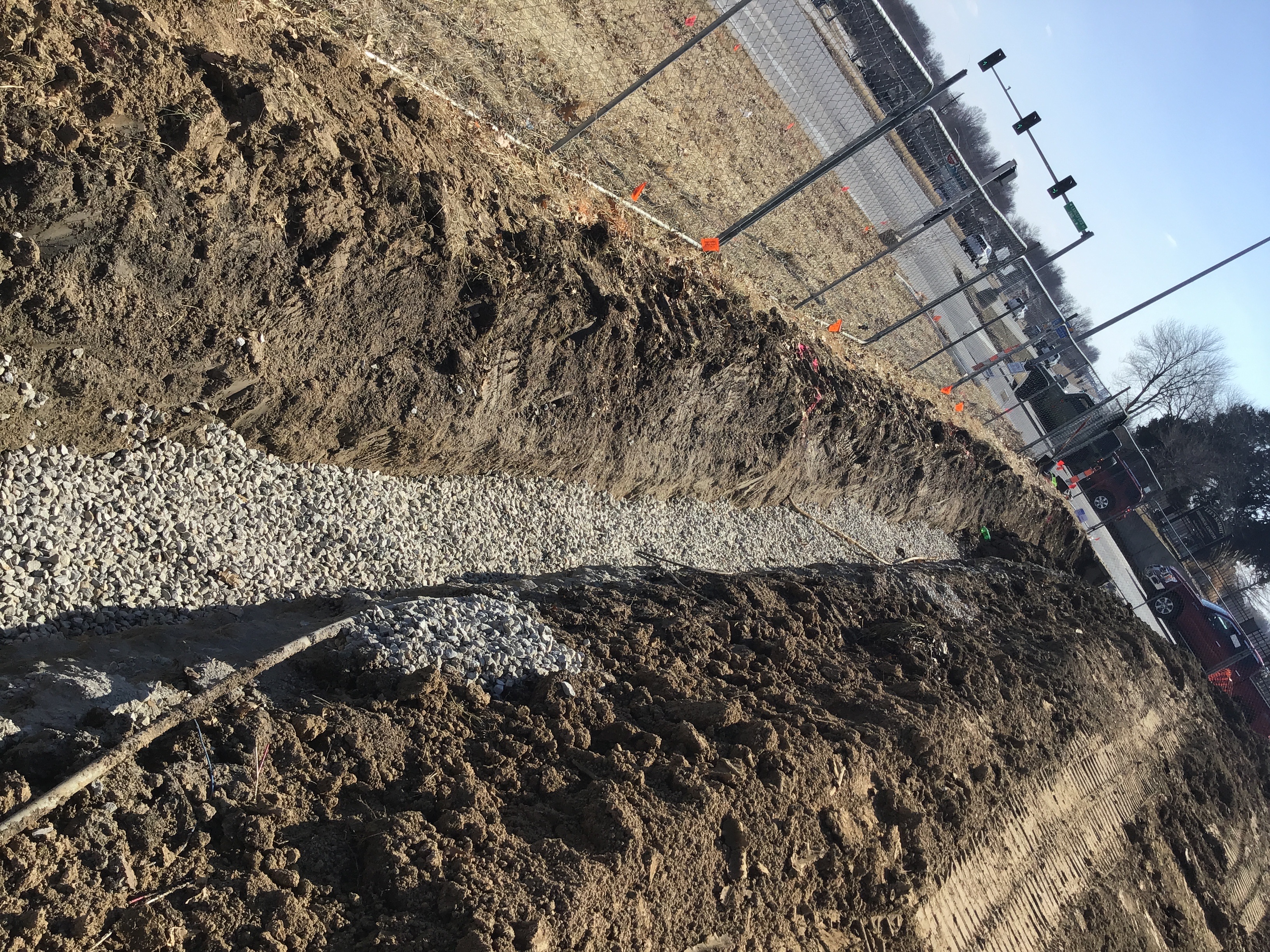

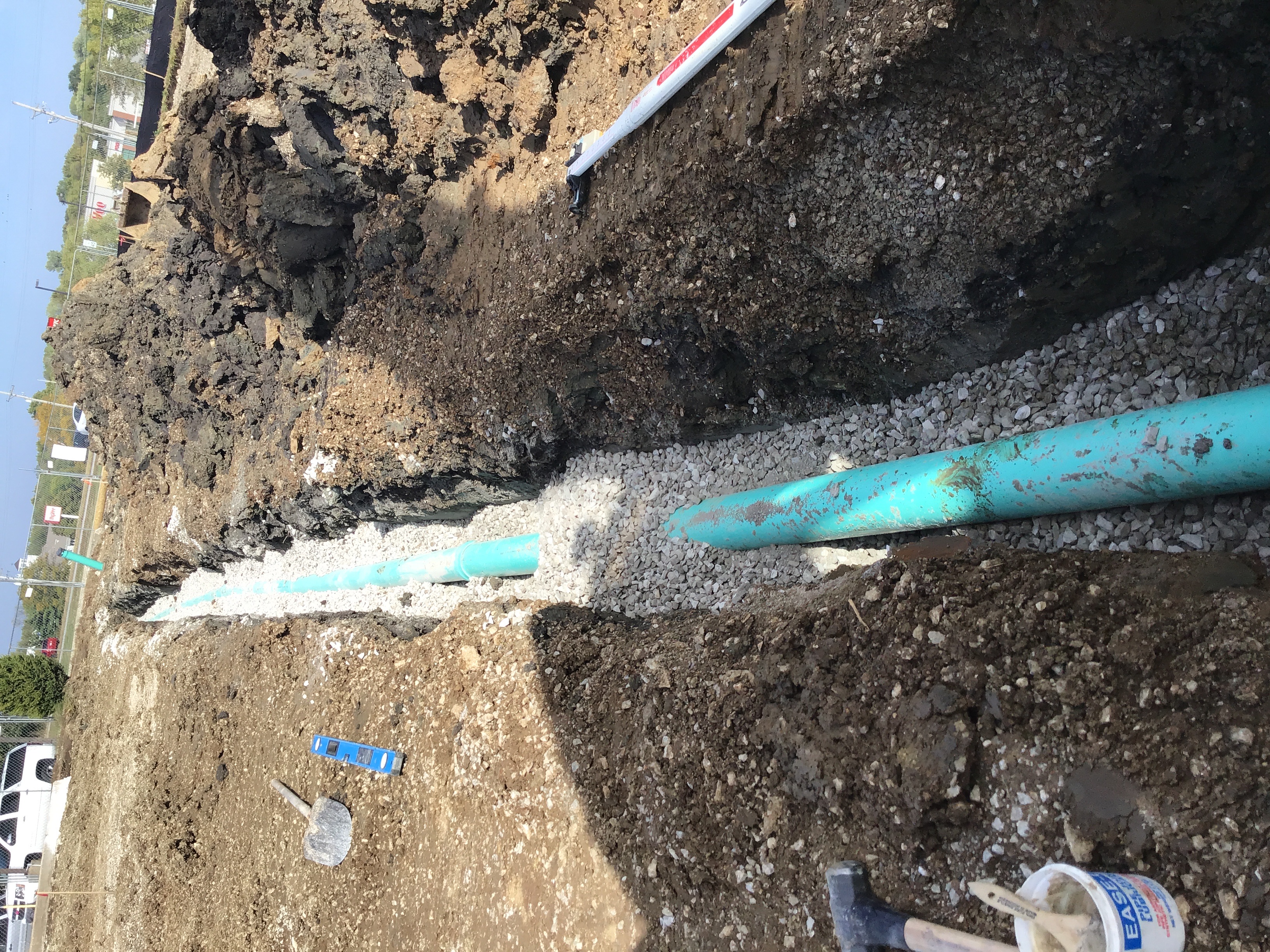

Water Line - Construction Inspection Partial 3/15/2022 03/15/2022
Misc
Informational
03/15/2022

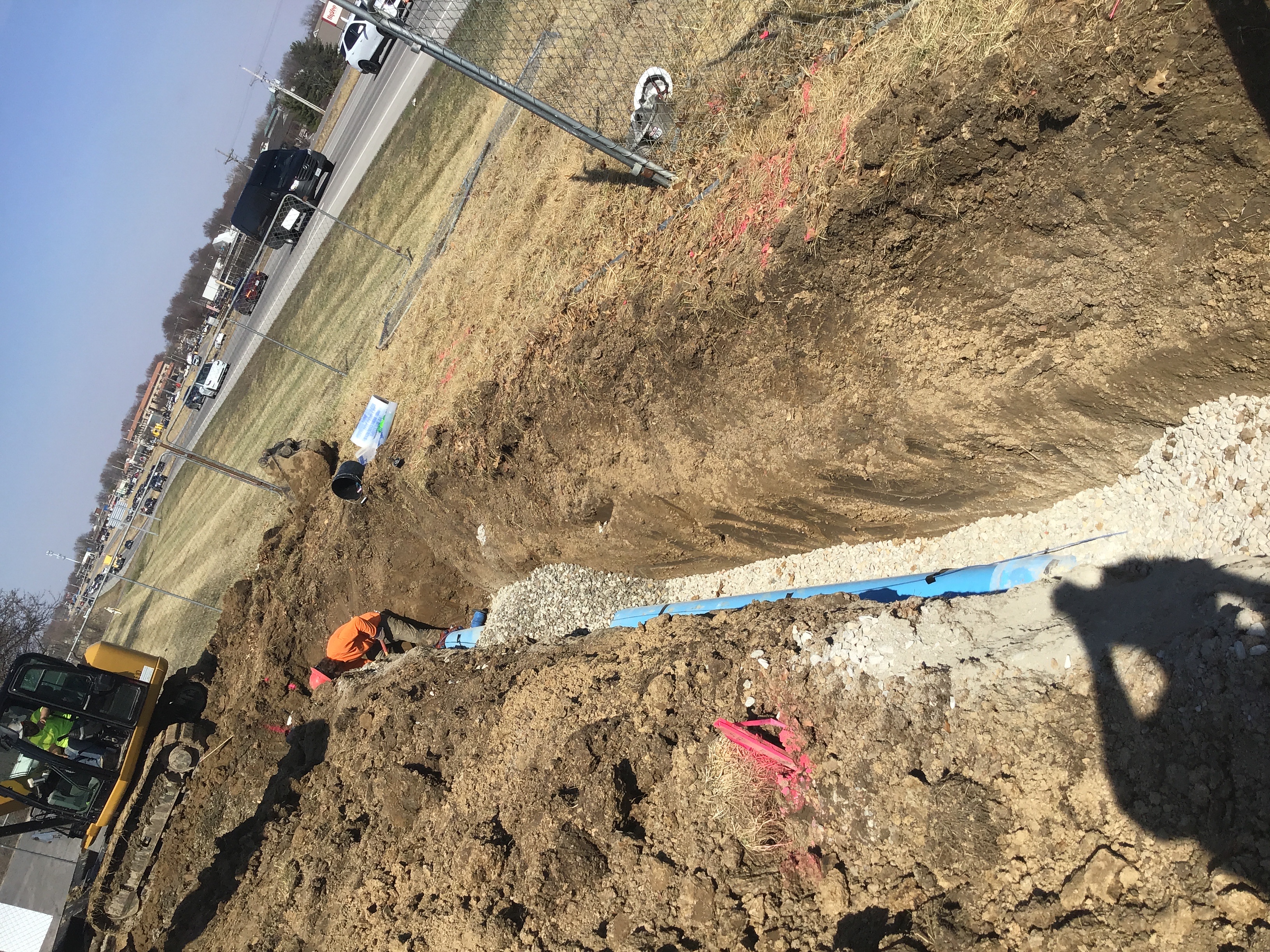

03/15/22 Tuesday (Wiedemann Inc.) Contractor installed approximately 140’ 0f 8”water main & a hydrant. 03/16/22 Wednesday (Wiedemann Inc.) Contractor made temporary Jumper tap on 8” existing water. Backing & straddle blocks will be poured today. Contractor completed work at site for the day and will return tomorrow. 03/17/22 Thursday (Wiedemann Inc.) Contractor had to make another temporary Jumper tap because the first was faulty. Pressure test of water main will be schedule for after lunch. Water line was Chlorinated after pressure test was completed. contractor plans to De-Chlorinate water line on 03/19/22 in order to take water sample on Monday 03/21/22. 03/29/22 Tuesday (Wiedemann Inc.) Water was shut 8:00AM notification were made last week and additional notices completed yesterday. Tie-in to 8” main has began. 45 & 22.5 degree bend, 8” sleeve, and 8”X8” Tee were installed. Backing blocks were poured for MJ fittings.
Water Line - Hydrostatic Test Passed 3/17/2022 03/17/2022
Misc
Informational
03/17/2022
03/17/22 (Wiedemann, INC.) 2 hour Hydrostatic Test passed.
Erosion Control Inspection Partial 3/18/2022 03/18/2022
Misc
Informational
03/18/2022
03/18/22 Erosion Control appears to be effective at site. 03/23/22 Wednesday Erosion control measure and devices have been stable. 08/02/22 Erosion Control appears to be effective at site.
Water Line - Abandonment Passed 4/1/2022 04/01/2022
Misc
Informational
04/01/2022
04/0122 Wiedemann Inc. Contractor demo existing 8” ductile water line approximately contractor will complete today.
Water Abandonment Passed 4/1/2022 04/01/2022
Misc
Informational
04/01/2022
04/01/22 Friday Wiedemann Inc. Contractor abandoned existing 8” DP. Approximately 140’ of pipe was removed from the East side of project running from South to North.
Sidewalk Inspection Partial 4/5/2022 04/05/2022
Misc
Informational
04/05/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan. Concrete schedule for 12:00 PM today to pour sidewalk.
Site Visit Partial 4/6/2022 04/06/2022
Misc
Informational
04/06/2022
04/06/22 Wednesday No work on related scope of work. Contractor are running electrical conduit and foundation. 04/11/22 Monday No work on related scope of work. 04/12/22 Tuesday No work on related scope of work. Appears contractors are working on building footings and foundation. 04/18/22 Monday No work on related scope of work. 04/21/22 Thursday No work on related scope of work. Contractor still working building pad.
Footing Inspection - Commercial Partial 4/7/2022 (8:00) 4/7/2022 04/07/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
04/07/2022
Line E from 1 to 6 Line A from 1 to 6 Line 1 from A to F
Underground Electrical Inspection - Commercial Passed 4/18/2022 4/18/2022 04/18/2022
Misc
Informational
04/18/2022
UFER LOCATED WEST FOOTING
Footing Inspection - Commercial Partial 4/18/2022 (1:00) 4/18/2022 04/18/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
04/07/2022
Line E from 1 to 6 Line A from 1 to 6 Line 1 from A to F - 4/18/22 COMPLETE FOOTING WEST SIDE, UFER IN NW FOOTING, 3 PADS -
Underslab Plumbing Inspection - Commercial Passed 4/25/2022 4/25/2022 04/25/2022
Footing Inspection - Commercial Partial 4/25/2022 (1:00) 4/25/2022 04/25/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
04/18/2022
Line E from 1 to 6 Line A from 1 to 6 Line 1 from A to F - 4/18/22 COMPLETE FOOTING WEST SIDE, UFER IN NW FOOTING, 3 PADS - - 4/25/22 TRASH ENCLOSURE FOOTING OK TO POUR -
Underslab Electrical Inspection - Commercial Passed 4/29/2022 4/29/2022 04/29/2022
Underslab Electrical Inspection - Commercial Passed 5/9/2022 5/9/2022 05/09/2022
Site Visit Partial 5/16/2022 05/16/2022
Misc
Informational
10/15/2021
10/15/21 Friday Met with contractor and City Lee’s Summit Project Engineer and a Water Supervisor. The topic of discussion is the location of valves and the relocation of the existing 8” water main from the foundation boundaries of the building.
Misc
Informational
05/16/2022
5/16/22 AN steel crew had a semi blocking the road on Langford . Spoke with contractor and they were getting it moved 08/02/22 JMJ ( Turner ) Spoke with contractor about some complaints that they have been getting from possibile Summit East Plaza Apartment about their workers parking on property.
In-wall Inspection Partial 6/7/2022 6/7/2022 06/07/2022
Misc
Informational
06/07/2022
-EXTERIOR FRAMING OK FOR SHEATHING
Underground Electrical Inspection - Commercial Partial 6/17/2022 06/17/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
06/17/2022
-Ground ring and conductor on west side of electrical room
In-wall Inspection Passed 6/30/2022 6/30/2022 06/30/2022
Misc
Resolved
06/30/2022
-EXTERIOR FRAMING OK FOR SHEATHING
Rated Assembly Inspection Partial 7/15/2022 7/15/2022 07/15/2022
Misc
Corrective Action Required
07/15/2022
7/15/22 - SCREW PATTERN AT DATA ROOM INTERIOR ONLY RESCHEDULE FOR SCREW PATTERN AFTER ROCK INSTALLED ON OUTSIDE OF DATA ROOM RATED ASSEMBLY
Gas Piping Inspection - Commercial Passed 7/28/2022 7/28/2022 07/28/2022

Electrical Service Inspection Partial 8/2/2022 8/2/2022 08/02/2022
Misc
Corrective Action Required
08/02/2022
ok to release. can see bonding bushing on interior of main panel and transfer on exterior.
Rated Assembly Inspection Partial 8/3/2022 08/03/2022
Misc
Corrective Action Required
07/15/2022
-SCREW PATTERN AT DATA ROOM BOTH SIDES
Curb - Proof Roll Partial 8/3/2022 08/03/2022
Misc
Informational
08/03/2022

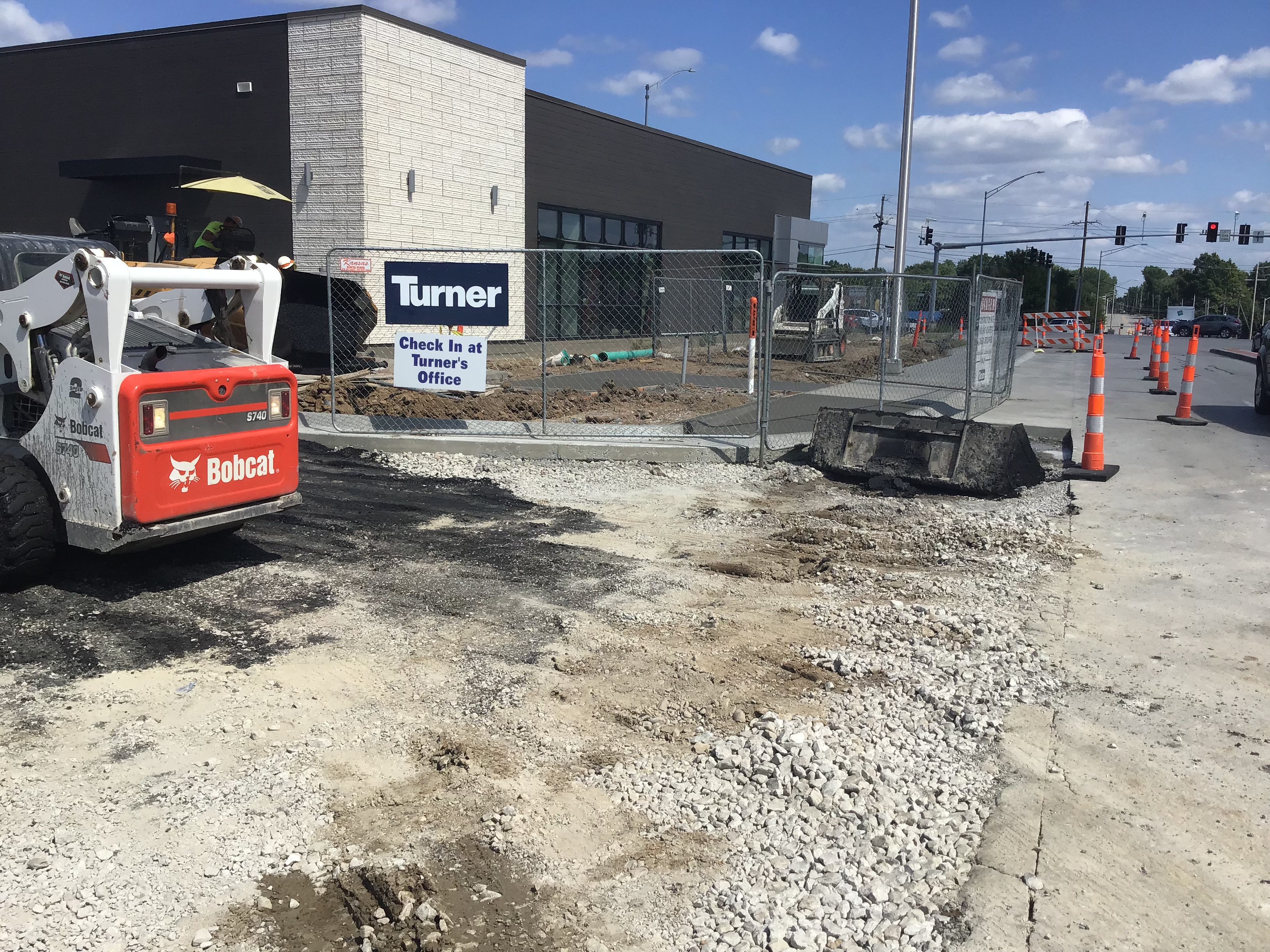

08/03/22 Wednesday JMJ ( Turner ) Contractor had set forms for curb pour, after visual inspection by inspector proof roll was pass. Subgrade was also passed 10/19/21 by third party inspection PSI ( Pavement-Stabilized Subgrade ). Concrete truck will be used to for additional curb proof roll because of the practicality ( the site is very congested ). Contractor poured curbs, there were shattered rain shower throughout the day. I will throughly inspect curbs tomorrow because site gates were closed.
Commercial Curb Inspection Partial 8/4/2022 08/04/2022
Misc
Informational
08/04/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today.
Commercial Curb Inspection Partial 8/5/2022 08/05/2022
Misc
Informational
08/04/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM.
Commercial Curb Inspection Partial 8/5/2022 08/05/2022
Misc
Informational
08/05/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM. Third party testing PSI was on site doing concrete slump test and collecting break cylinders.
Commercial Curb Inspection Partial 8/5/2022 08/05/2022
Misc
Informational
08/05/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM. Third party testing PSI was on site doing concrete slump test and collecting break cylinders.
Electrical Service Inspection Passed 8/5/2022 8/5/2022 08/05/2022
Misc
Resolved
08/05/2022
ok to release. can see bonding bushing on interior of main panel and transfer on exterior.
Above Ceiling Inspection Partial 8/5/2022 8/5/2022 08/05/2022
THE FOLLOWING AREAS ARE APPROVED
Informational
08/05/2022
HARD LIDS AT 118, 103-105
Site Visit Partial 8/8/2022 08/08/2022
Misc
Informational
05/16/2022
04/06/22 Wednesday No work on related scope of work. Contractor are running electrical conduit and foundation. 04/11/22 Monday No work on related scope of work. 04/12/22 Tuesday No work on related scope of work. Appears contractors are working on building footings and foundation. 04/18/22 Monday No work on related scope of work. 04/21/22 Thursday No work on related scope of work. Contractor still working building pad. 08/08/22 Monday Contractor was clearing and cleaning site no directly related work.
Footing Inspection - Commercial Failed 8/9/2022 (9:00) 8/9/2022 08/09/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
04/25/2022
Line E from 1 to 6 Line A from 1 to 6 Line 1 from A to F - 4/18/22 COMPLETE FOOTING WEST SIDE, UFER IN NW FOOTING, 3 PADS - - 4/25/22 TRASH ENCLOSURE FOOTING OK TO POUR - *8/9/22-CLARIFY DETAIL FOR ATM PAD

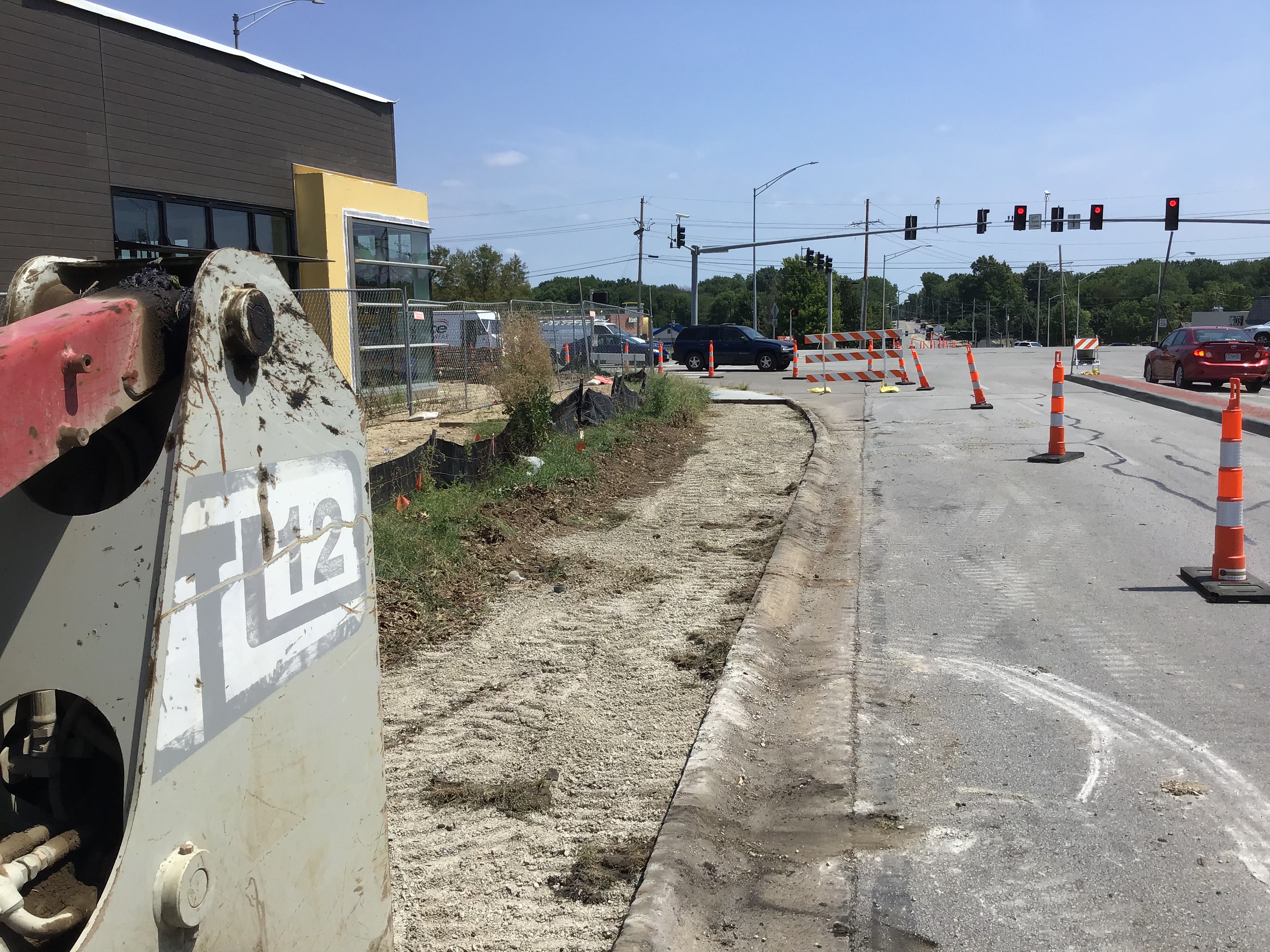

Street - Median Passed 8/10/2022 08/10/2022
Misc
Informational
08/10/2022
08/10/22 Wednesday JMJ ( Leavcon concrete / Tuner ) Contractor installed forms for the new constructed median along Langford Rd. Curbs are schedule to be poured tomorrow @ 10:30AM.
Street - Median Passed 8/11/2022 08/11/2022
Misc
Informational
08/11/2022
08/11/22 Thursday JMJ ( Sub-contractor Leavcon Concrete Const. ) Contractor is starting to pour the curbs for the street median. Concrete was tested by PSI third party testing company.
Street - Median Passed 8/12/2022 08/12/2022
Misc
Informational
08/12/2022
08/12/22 Friday JMJ ( Leavcon Concrete Const. ) Contractor continued construction of street - median. The concrete arrived at 11:50AM to pour red dye concrete that will stamped to look red bricks for the median. PSI is the third party inspector for the concrete.

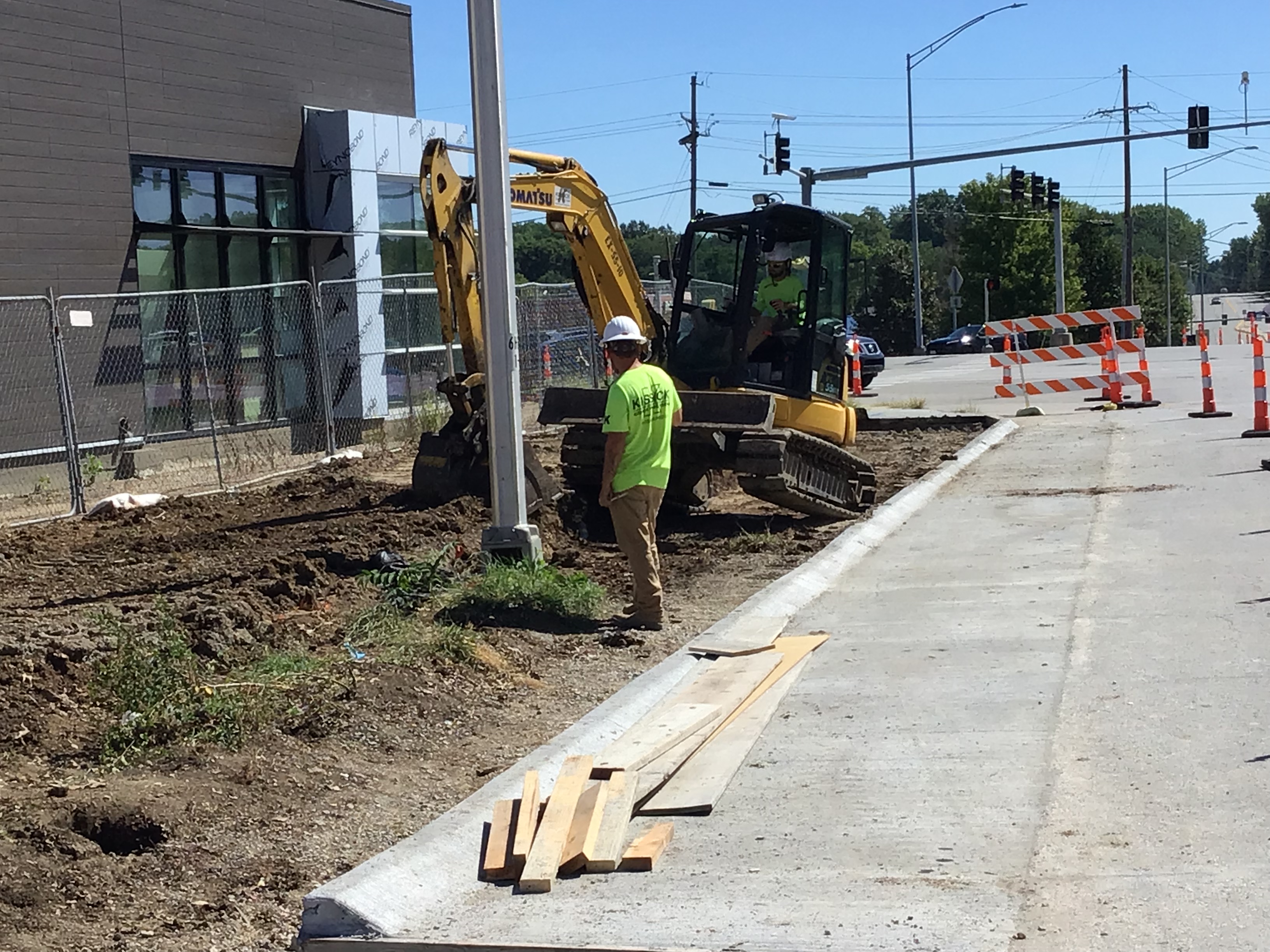

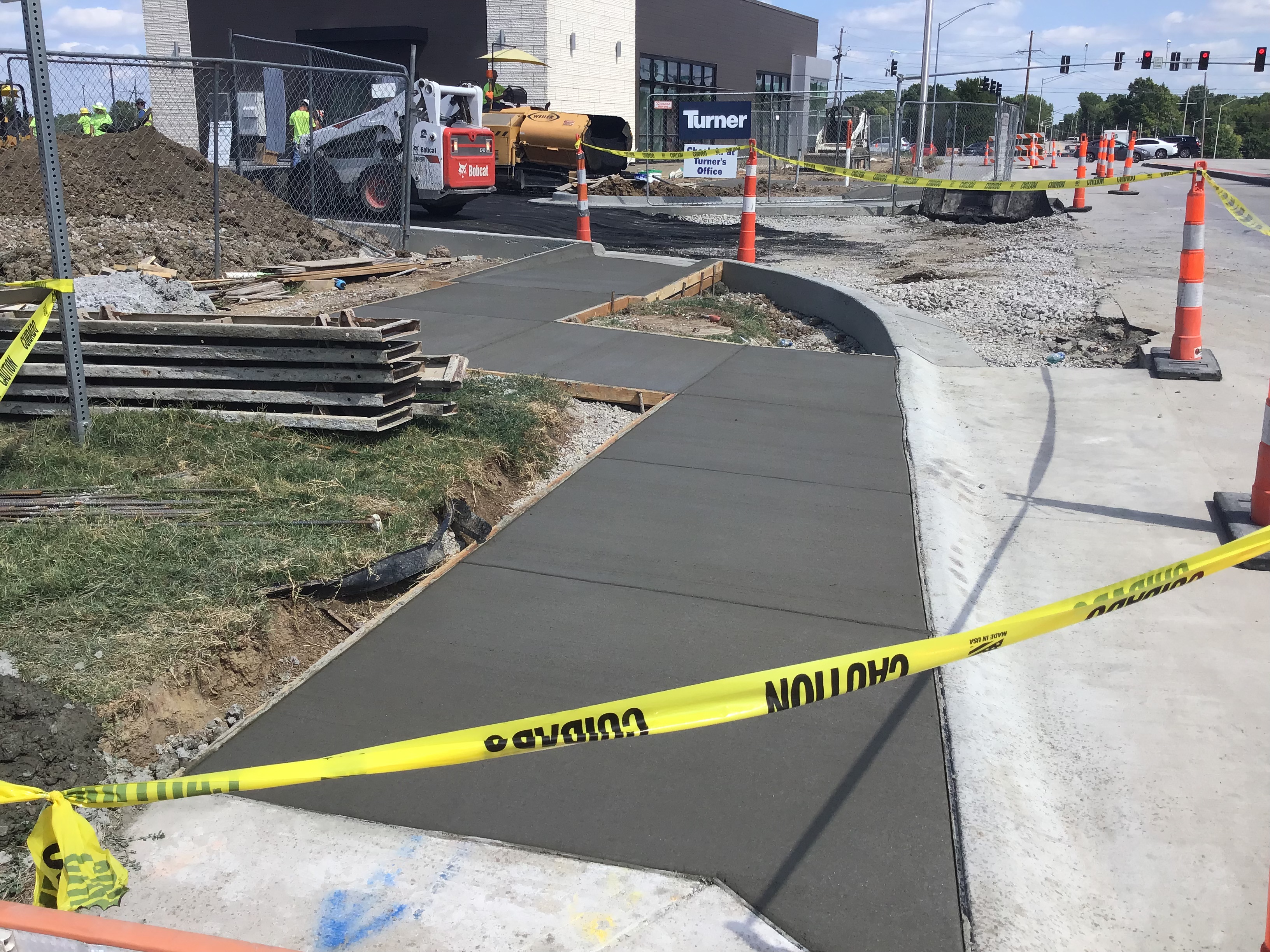

Sidewalk Inspection Partial 8/15/2022 08/15/2022
Misc
Informational
04/05/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan.
Misc
Informational
08/15/2022
08/15/22 Monday JMJ ( Kissick Const. ) Contractor began demolition of sidewalk as-per project plans.
Sidewalk Inspection Partial 8/17/2022 08/17/2022
Misc
Informational
08/15/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan.
Misc
Informational
08/15/2022
08/15/22 Monday JMJ ( Kissick Const. ) Contractor began demolition of sidewalk as-per project plans. 08/17/22 Wednesday JMJ ( Kissick Const. ) Contractor was able to continue removal of existing sidewalk after yesterday rain day. Subgrade under recently removed sidewalk was stable. 8/18/22 Thursday JMJ ( Kissick Const. ) Contractor has survey crew staking curb and sidewalks along Langsford Rd. ( Leavcon ) is pour concrete to the newly built Chase Bank on the Northside of building. Rebar is installed for the sidewalk parallel and the vertical front. PSI the third party inspection company/ is test Geiger concrete mix.
Sidewalk Inspection Partial 8/19/2022 08/19/2022
Misc
Informational
08/17/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan.
Misc
Informational
08/17/2022
08/15/22 Monday JMJ ( Kissick Const. ) Contractor began demolition of sidewalk as-per project plans. 08/17/22 Wednesday JMJ ( Kissick Const. ) Contractor was able to continue removal of existing sidewalk after yesterday rain day. Subgrade under recently removed sidewalk was stable. 08/19/22 Friday JMJ ( Leavcon ) Sidewalk leading to the entrance of the building was completed on the Northside of the Chase Bank. ( Kissick Const. ) Contractor will be grading subgrade and possible forming frames for curbs and sidewalks.
Commercial Curb Inspection Partial 8/22/2022 08/22/2022
Misc
Informational
08/05/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM. Third party testing PSI was on site doing concrete slump test and collecting break cylinders. 08/22/22 Monday JMJ ( Leavcon Concrete ) Contractor continued to pour curbs in parking lot area of Chase Bank.
Sidewalk Inspection Partial 8/22/2022 08/22/2022
Misc
Informational
08/19/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan.
Misc
Informational
08/19/2022
08/15/22 Monday JMJ ( Kissick Const. ) Contractor began demolition of sidewalk as-per project plans. 08/17/22 Wednesday JMJ ( Kissick Const. ) Contractor was able to continue removal of existing sidewalk after yesterday rain day. Subgrade under recently removed sidewalk was stable. 08/19/22 Friday JMJ ( Leavcon ) Sidewalk leading to the entrance of the building was completed on the Northside of the Chase Bank. ( Kissick Const. ) Contractor will be grading subgrade and possible forming frames for curbs and sidewalks. 08/22/22 Monday JMJ ( Kissick Const ) Contractor continued to grade ground were sidewalk was removed & for construction of new sidewalks.
Site Visit Partial 8/23/2022 08/23/2022
Misc
Informational
08/08/2022
04/06/22 Wednesday No work on related scope of work. Contractor are running electrical conduit and foundation. 04/11/22 Monday No work on related scope of work. 04/12/22 Tuesday No work on related scope of work. Appears contractors are working on building footings and foundation. 04/18/22 Monday No work on related scope of work. 04/21/22 Thursday No work on related scope of work. Contractor still working building pad. 08/08/22 Monday Contractor was clearing and cleaning site no directly related work. 08/23/22 Tuesday JMJ ( Leavcon Construction ) Contractor has been working in concert with other contractor to install ATM. Leavcon Const. poured concrete for ATM base structure.
Sidewalk Inspection Passed 8/26/2022 08/26/2022
Misc
Informational
08/22/2022
04/05/22 Tuesday Contractor constructed formed to replace sidewalk that was removed to relocate 8” water line as per plan.
Misc
Informational
08/22/2022
08/15/22 Monday JMJ ( Kissick Const. ) Contractor began demolition of sidewalk as-per project plans. 08/17/22 Wednesday JMJ ( Kissick Const. ) Contractor was able to continue removal of existing sidewalk after yesterday rain day. Subgrade under recently removed sidewalk was stable. 08/19/22 Friday JMJ ( Leavcon ) Sidewalk leading to the entrance of the building was completed on the Northside of the Chase Bank. ( Kissick Const. ) Contractor will be grading subgrade and possible forming frames for curbs and sidewalks. 08/22/22 Monday JMJ ( Kissick Const ) Contractor continued to grade ground were sidewalk was removed & for construction of new sidewalks. 08/2622 Friday JMJ ( Leavcon ) Contractor forming frame for sidewalk on the North & West corners of building project.
Commercial Curb Inspection Partial 8/26/2022 08/26/2022
Misc
Informational
08/22/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM. Third party testing PSI was on site doing concrete slump test and collecting break cylinders. 08/22/22 Monday JMJ ( Leavcon Concrete ) Contractor continued to pour curbs in parking lot area of Chase Bank. 08/26/22 Friday JMJ ( Leavcon Concrete ) Contractor began pouring curbs along NE Langsford RD for curbs and sidewalks as-per project plans.
Commercial Curb Inspection Partial 8/30/2022 08/30/2022
Misc
Informational
08/26/2022
08/04/22 Thursday JMJ ( Turner ) Approximately 100’ of curb was poured for the parking lot yesterday. Patching on the backside of curbs shall be done to fill in voids. Approximately 150’ of curb will be poured around 10:30AM today. 08/05/22 Friday JMJ ( Turner/ Leavcon Concrete ) Approximately 80’ of curb will be formed and poured today. Pouring of concrete will be around 11:00 AM. Third party testing PSI was on site doing concrete slump test and collecting break cylinders. 08/22/22 Monday JMJ ( Leavcon Concrete ) Contractor continued to pour curbs in parking lot area of Chase Bank. 08/26/22 Friday JMJ ( Leavcon Concrete ) Contractor began pouring curbs along NE Langsford RD for curbs and sidewalks as-per project plans. 08/30/22 Tuesday JMJ ( Leavcon Concrete ) Contractor poured curbs along Langsford Road to Hwy 291 on 08/29/22 Monday.
Pavement-Surface Partial 8/31/2022 08/31/2022
Misc
Informational
08/31/2022
08/31/22 Wednesday JMJ ( Leavcon Concrete ) Concrete was poured for the dumpster area. Forms and materials were set in handicap area .
Sidewalk Inspection Partial 8/31/2022 08/31/2022
Misc
Informational
08/31/2022
08/31/22 Wednesday ( Kissick Construction ) Contractor to install forms and materials for sidewalk.
Sidewalk Inspection Partial 9/6/2022 09/06/2022
Misc
Informational
08/31/2022
08/31/22 Wednesday ( Kissick Construction ) Contractor to install forms and materials for sidewalk.
Misc
Informational
09/06/2022
09/06/22 Tuesday JMJ ( Leavcon Const. ) Contractor poured sidewalk along NE Langsford Road as-per project plans.
Erosion Control Inspection Passed 9/6/2022 09/06/2022
Misc
Informational
09/06/2022
09/06/22 Tuesday JMJ Erosion control measure are still working.
Sidewalk Inspection Partial 9/7/2022 09/07/2022
Misc
Informational
09/06/2022
08/31/22 Wednesday ( Kissick Construction ) Contractor to install forms and materials for sidewalk.
Misc
Informational
09/06/2022
09/06/22 Tuesday JMJ ( Leavcon Const. ) Contractor poured sidewalk along NE Langsford Road as-per project plans. 09/07/22 Wednesday JMJ ( Leavcon Const. ) Contractor continues to pour sidewalk along NE Langsford Road West of Chase Bank Building. PSI is the third party inspector on site.
Pavement-Aggregate Base Partial 9/7/2022 09/07/2022
Misc
Informational
08/30/2022
08/30/22 Tuesday JMJ ( Leavcon Concrete ) Concrete pad was framed with steel meshing for dumpster.
Misc
Informational
09/07/2022
09/07/22 Wednesday JMJ ( Hanrahan Asphalt Paving Co, Inc. ) Contractor began paving parking lot with APWA Tpye 2 Rec for aggregate base asphalt. Olsson was the third party test believe that all result have , so far been within tolerance. Last true will soon be arriving on site 11.42AM.
Pavement-Aggregate Base Partial 9/7/2022 09/07/2022
Misc
Informational
09/07/2022
08/30/22 Tuesday JMJ ( Leavcon Concrete ) Concrete pad was framed with steel meshing for dumpster.
Misc
Informational
09/07/2022
09/07/22 Wednesday JMJ ( Hanrahan Asphalt Paving Co, Inc. ) Contractor began paving parking lot with APWA Tpye 2 Rec for aggregate base asphalt. PSI was the third party test believe that all result have, so far been within tolerance. Last true will soon be arriving on site 11.42AM.
Sidewalk Inspection Partial 9/7/2022 09/07/2022
Misc
Informational
09/07/2022
08/31/22 Wednesday ( Kissick Construction ) Contractor to install forms and materials for sidewalk.
Misc
Informational
09/07/2022
09/06/22 Tuesday JMJ ( Leavcon Const. ) Contractor poured sidewalk along NE Langsford Road as-per project plans. 09/07/22 Wednesday JMJ ( Leavcon Const. ) Contractor continues to pour sidewalk along NE Langsford Road West of Chase Bank Building. PSI is the third party inspector on site.
Piers/Caissons Inspection - Commercial Passed 9/12/2022 09/12/2022
Misc
Informational
09/12/2022
6 LIGHT POLE BASES 7 # 5 BARS WRAPPED EVERY 12" W/ # 3 BARS. DRIVEN GROUND ROD AT EACH CAGE
Above Ceiling Inspection Failed 9/13/2022 9/13/2022 09/13/2022
THE FOLLOWING AREAS ARE APPROVED
Informational
08/05/2022
HARD LIDS AT 118, 103-105
Miscellaneous Correction
Corrective Action Required
09/13/2022
Provide cover plates open j boxes 101,102,108,117.119,107,115,116,117 Complete ceiling grid 119,106 Seal penetrations 1 hour wall data room
Rated Assembly Inspection Failed 9/14/2022 09/14/2022
Misc
Corrective Action Required
08/03/2022
-SCREW PATTERN AT DATA ROOM BOTH SIDES
Miscellaneous Correction
Corrective Action Required
09/14/2022
SEAL PENETRATIONS 1 HOUR WALL IN DATA ROOM
Above Ceiling Inspection Passed 9/15/2022 9/15/2022 09/15/2022
THE FOLLOWING AREAS ARE APPROVED
Informational
09/13/2022
HARD LIDS AT 118, 103-105
Miscellaneous Correction
Resolved
09/15/2022
Underground Electrical Inspection - Commercial Passed 9/15/2022 09/15/2022
THE FOLLOWING AREAS ARE APPROVED
Corrective Action Required
06/17/2022
-Ground ring and conductor on west side of electrical room
Rated Assembly Inspection Passed 9/15/2022 09/15/2022
Misc
Informational
09/15/2022
-SCREW PATTERN AT DATA ROOM BOTH SIDES
Miscellaneous Correction
Resolved
09/15/2022
Gas Service Inspection - Commercial Passed 9/15/2022 09/15/2022
Occupancy Inspection - Codes Commercial Failed 9/19/2022 9/19/2022 09/19/2022
Miscellaneous Correction
Corrective Action Required
09/19/2022
Provide cover open circuit breaker service panel Install ceiling tiles Label RTU disconnect to match service panel RTU GFCI not working Complete media wall Install backordered glass entry door Label service panel Provide documentation Clarifying atm footing inspection Pending field engineering, fire, planning Approval Ok to move furniture in NO OCCUPANCY
Occupancy Inspection - Fire Failed 9/19/2022 9/19/2022 09/19/2022
09/19/2022
FD1011.1 Where required. Exit Signs.
Corrective Action Required
09/19/2022
Exits and exit access doors shall be marked by an approved exit sign readily visible from any direction of egress travel. Access to exits shall be marked by readily visible exit signs in cases where the exit or the path of egress travel is not immediately visible to the occupants. Exit sign placement shall be such that no point in a corridor is more than 100 feet (30 480 mm) or the listed viewing distance for the sign, whichever is less, from the nearest visible exit sign.Exceptions:1. Exit signs are not required in rooms or areas that require only one exit or exit access.2. Main exterior exit doors or gates that are obviously and clearly identifiable as exits need not have exit signs where approved by the fire code official.3. Exit signs are not required in occupancies in Group U and individual sleeping units or dwelling units in Group R-1, R-2 or R-3.4. Exit signs are not required in sleeping areas in occupancies in Group I-3.5. In occupancies in Groups A-4 and A-5, exit signs are not required on the seating side of vomitories or openings into seating areas where exit signs are provided in the concourse that are readily apparent from the vomitories. Egress lighting is provided to identify each vomitory or opening within the seating area in an emergency. -------------------------------------- An approved pictorial sign of a standardized design shall be posted adjacent to each elevator call station on all floors instructing occupants to use the exit stairways and not to use the elevators in case of fire. The sign shall read: IN FIRE EMERGENCY, DO NOT USE ELEVATOR. USE EXIT STAIRS. The emergency sign shall not be required for elevators that are part of an accessible means of egress complying with Section 1007.4. Action required- Fix exit sign in front vestibule
FD505.1 Address Numbers
Corrective Action Required
09/19/2022
New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In multi-tenant commercial buildings where tenants have multiple entrances located on different sides of the building, each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). Action Required- Add address to front of building over door, additional address Langsford St side of building.
Occupancy Inspection - Planning Temporary C of O 9/19/2022 9/19/2022 09/19/2022
Miscellaneous Correction
Corrective Action Required
09/19/2022
Complete landscaping and screen buffer (fence).
Miscellaneous Correction
Corrective Action Required
09/19/2022
Install trash enclosure gates
Occupancy Inspection - Water Utilities Temporary C of O 9/19/2022 9/19/2022 09/19/2022
Miscellaneous Correction
Corrective Action Required
09/19/2022
Provide backflow test results for the domestic and irrigation backflows.
Occupancy Inspection - Engineering Failed 9/19/2022 9/19/2022 09/20/2022
Misc
Informational
09/20/2022
Needed for TCO 1. All signs on the island need to be installed, refer to sheet C21 for signs. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Occupancy Inspection - Fire Passed 09/21/2022
Misc
Corrective Action Required
09/21/2022
Final approval for permits issued through Developmental Services.
Occupancy Inspection - Engineering Temporary C of O 9/21/2022 09/21/2022
Misc
Informational
09/20/2022
Needed for TCO 1. All signs on the island need to be installed, refer to sheet C21 for signs. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Misc
Informational
09/21/2022
TCO is given. Temporary signs have been installed and need to be maintained until permanent have been installed. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Occupancy Inspection - Codes Commercial Ready for Temp CO 9/20/2022 09/21/2022
Miscellaneous Correction
Corrective Action Required
09/19/2022
PAY NOT READY FEES Provide documentation Clarifying atm footing inspection Pending field engineering, fire, Approval for TCO Ok to move furniture in NO OCCUPANCY
Occupancy Inspection - Codes Commercial Temporary C of O 09/21/2022
Miscellaneous Correction
Corrective Action Required
09/21/2022
Provide documentation Clarifying atm footing inspection Complete items for Planning, Water and Field Engineering
Occupancy Inspection - Codes Commercial Temporary C of O 09/21/2022
Miscellaneous Correction
Corrective Action Required
09/21/2022
Provide documentation Clarifying atm footing inspection Complete items for Planning, Water and Field Engineering
Record Drawing Review Partial 10/6/2022 10/11/2022
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ The signs for the median don’t meet specifications. All portions of As-Built pass.
Occupancy Inspection - Engineering Failed 10/11/2022 10/11/2022
Misc
Informational
09/21/2022
Needed for TCO 1. All signs on the island need to be installed, refer to sheet C21 for signs. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Misc
Informational
09/21/2022
TCO is given. Temporary signs have been installed and need to be maintained until permanent have been installed. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Informational
10/11/2022
Needed for Final Occupancy 1 .Maintenance bond 2. Final affidavit and agreement. 3. The 2 R4-7 signs in the median need to be replaced with a 18x24 sign.
Occupancy Inspection - Planning Passed 10/18/2022
Miscellaneous Correction
Resolved
10/18/2022
Complete landscaping and screen buffer (fence).
Miscellaneous Correction
Resolved
10/18/2022
Install trash enclosure gates
Occupancy Inspection - Codes Commercial Ready for Temp CO 10/24/2022 10/24/2022
Miscellaneous Correction
Corrective Action Required
09/21/2022
Provide documentation Clarifying atm footing inspection Complete items for Water and Field Engineering
Record Drawing Review Passed 10/18/2022 10/24/2022
Misc
Informational
10/11/2022
10/11/22 Tuesday JMJ The signs for the medium don’t meet specifications. All portions of As-Built pass. 10/24/24 Monday JMJ Signs were replaced with the correct size.
Footing Inspection - Commercial Passed 10/27/2022 10/27/2022
THE FOLLOWING AREAS ARE APPROVED
Resolved
10/27/2022
Line E from 1 to 6 Line A from 1 to 6 Line 1 from A to F - 4/18/22 COMPLETE FOOTING WEST SIDE, UFER IN NW FOOTING, 3 PADS - - 4/25/22 TRASH ENCLOSURE FOOTING OK TO POUR - *8/9/22-CLARIFY DETAIL FOR ATM PAD
Occupancy Inspection - Engineering Passed 11/3/2022 11/03/2022
Misc
Informational
10/11/2022
Needed for TCO 1. All signs on the island need to be installed, refer to sheet C21 for signs. Needed for Final Occupancy 1. As-builts on island and lane extension 2. Maintenance bond 3. Final Affidavit and Agreement 4. Finish sodding and vegetation. 5. Clean up and remove all debris from site.
Misc
Informational
11/03/2022
All items have been completed on our punch list.
Install Street and Stop Signs Passed 11/07/2022
Occupancy Inspection - Water Utilities Passed 11/07/2022
Miscellaneous Correction
Corrective Action Required
09/19/2022
Provide backflow test results for the domestic and irrigation backflows.
Occupancy Inspection - Codes Commercial Ready for Temp CO 11/18/2022
Miscellaneous Correction
Corrective Action Required
10/24/2022
Provide stamped copy of the record drawings for the ROW improvements.
Occupancy Inspection - Codes Commercial Full C of O 11/22/2022
Miscellaneous Correction
Resolved
11/22/2022
Provide stamped copy of the record drawings for the ROW improvements.
Documents & Images
Date Uploaded File Type Document Name
05/04/2021 Application Form Chase Bank - Building Permit App
05/10/2021 Letter Fire Building Plan Review
05/11/2021 Letter DS P/R Corrections Document
06/17/2021 Engineer Report/Study Chase - HWY 291 and NE Langsford - COMcheck
06/17/2021 Engineer Report/Study Chase - HWY 291 and NE Langsford - GEOTECH Report
06/17/2021 Engineer Report/Study Chase - HWY 291 and NE Langsford -MP HVAC Load
06/17/2021 Specifications Chase - HWY 291 and NE Langsford - Project Manual
06/17/2021 Letter Chase HWY 291 and NE Langsford Rd REV 2 Response Letter
06/17/2021 Engineer Report/Study Chase - HWY 291 and NE Langsford -STRUCT Calculations
06/17/2021 Plans Chase - HWY 291 and SE Langsford REV #2
06/17/2021 Letter Fire Building Plan Review
07/02/2021 Letter CPTED response - Chase Hwy 291 & NE Langsford-Lee's Summit MO-CSG signed
07/07/2021 Email CPTED - PD approval
08/12/2021 Receipt Receipt for transaction: 2021-006474
08/12/2021 Letter DS Building Permit
08/13/2021 Approved Plans Approved Chase Bank Civil Plans 8.13.2021
08/13/2021 Approved Plans Approved Chase Bank Building Plans 8.13.2021
08/16/2021 Application Form License_Tax_Application (Turner)
10/04/2021 image.jpg
10/04/2021 image.jpg0
10/04/2021 image.jpg1
10/08/2021 Letter INSPECTION SUMMARY
10/08/2021 image.jpg2
10/08/2021 Letter INSPECTION SUMMARY
10/12/2021 image.jpg3
10/12/2021 image.jpg4
10/12/2021 image.jpg5
10/12/2021 Letter INSPECTION SUMMARY
10/12/2021 Letter INSPECTION SUMMARY
10/14/2021 image.jpg6
10/14/2021 image.jpg7
10/14/2021 Letter INSPECTION SUMMARY
10/15/2021 Letter INSPECTION SUMMARY
10/19/2021 Letter INSPECTION SUMMARY
10/20/2021 Letter INSPECTION SUMMARY
10/22/2021 Letter INSPECTION SUMMARY
11/04/2021 Letter MDNR NFA Letter
03/11/2022 Approved Plans Chase Bank Water Main Relocation Approved 3.11.22
03/15/2022 image
03/15/2022 image0
03/15/2022 image1
03/15/2022 Letter INSPECTION SUMMARY
03/16/2022 image2
03/16/2022 image3
03/16/2022 Letter INSPECTION SUMMARY
03/17/2022 Letter INSPECTION SUMMARY
03/21/2022 Approved Plans Approved Revised Set 2022_03_08 Chase Bank - Lees Summit MO - Civil Rev7_SS
03/23/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
03/29/2022 image4
03/29/2022 image5
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 image6
04/01/2022 image7
04/01/2022 image8
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 Letter INSPECTION SUMMARY
04/01/2022 image9
04/01/2022 image10
04/01/2022 Letter INSPECTION SUMMARY
04/05/2022 image11
04/05/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/05/2022 image12
04/05/2022 image13
04/06/2022 Letter INSPECTION SUMMARY
04/07/2022 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
04/18/2022 Letter INSPECTION SUMMARY
04/18/2022 Letter INSPECTION SUMMARY
04/25/2022 Letter INSPECTION SUMMARY

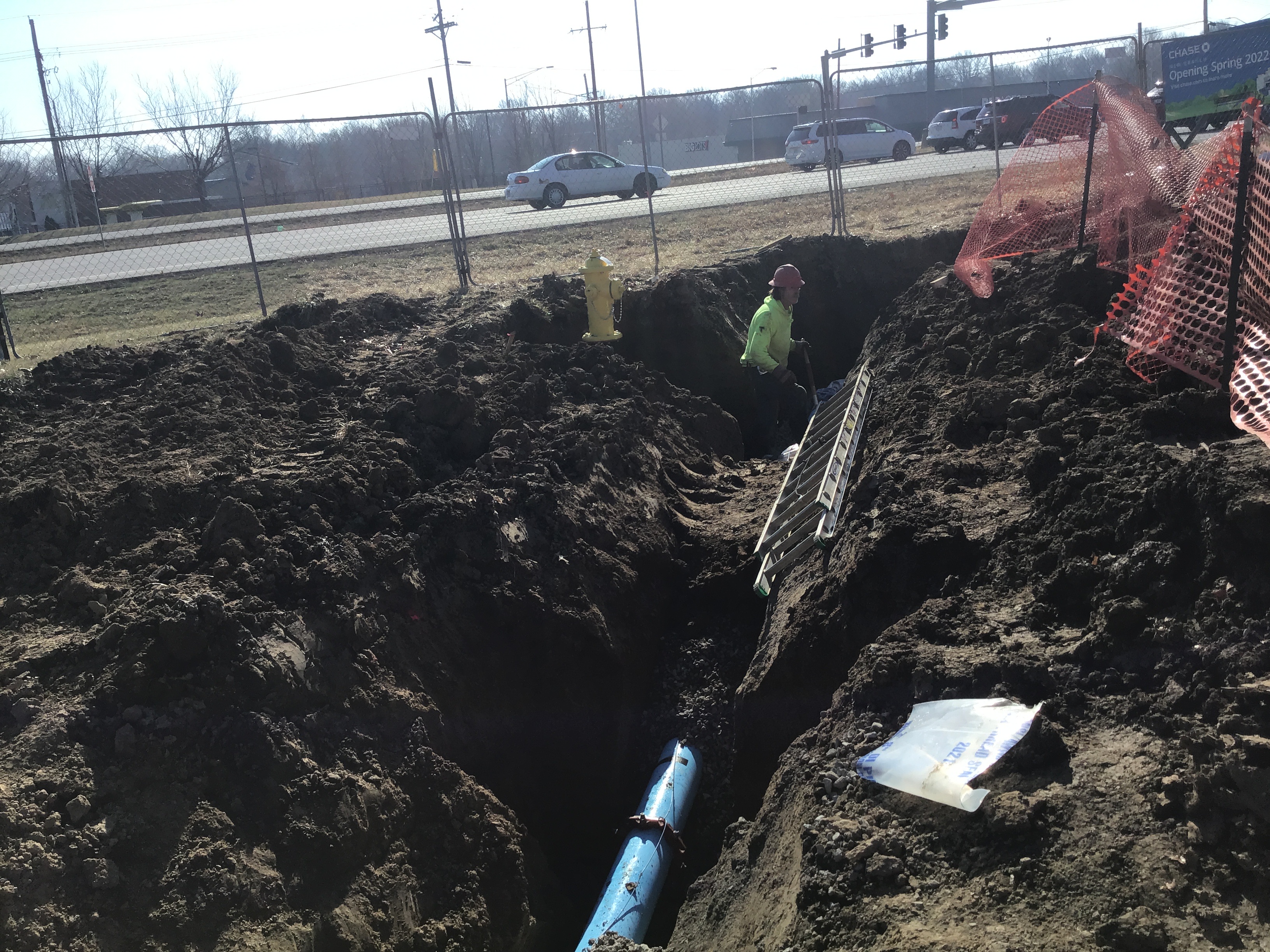

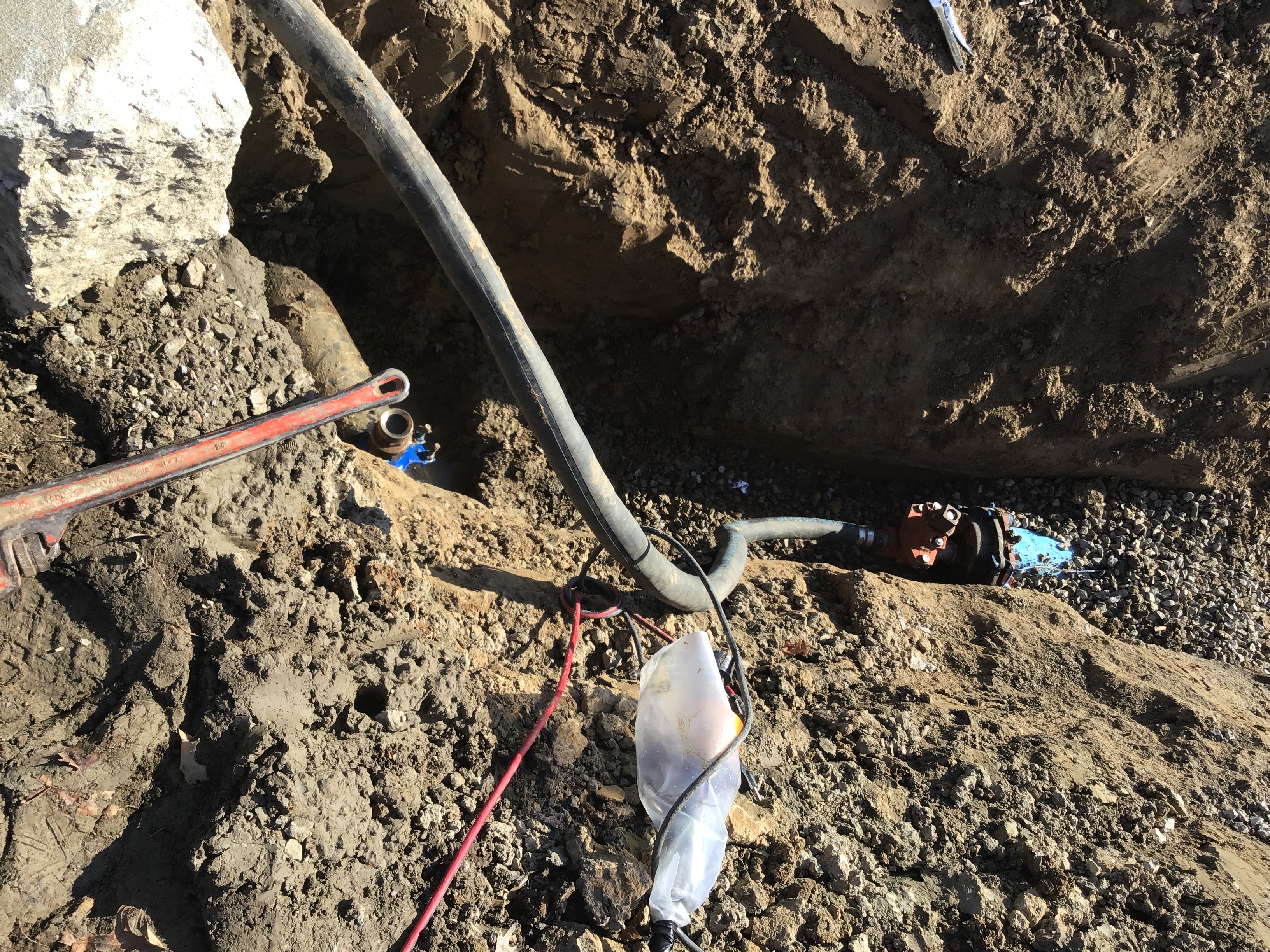

04/25/2022 Letter INSPECTION SUMMARY
04/29/2022 Letter INSPECTION SUMMARY
05/09/2022 Letter INSPECTION SUMMARY
06/07/2022 Letter INSPECTION SUMMARY
06/17/2022 Letter INSPECTION SUMMARY
06/30/2022 Letter INSPECTION SUMMARY
07/15/2022 Letter INSPECTION SUMMARY
07/28/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/03/2022 Letter INSPECTION SUMMARY
08/03/2022 image14
08/03/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/04/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter INSPECTION SUMMARY
08/05/2022 image15
08/05/2022 image16
08/05/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter INSPECTION SUMMARY
08/05/2022 4CA6CC63-48FA-474F-9ACD-0233A5B00F33
08/05/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter INSPECTION SUMMARY
08/05/2022 Letter INSPECTION SUMMARY
08/08/2022 Letter INSPECTION SUMMARY
08/09/2022 Letter INSPECTION SUMMARY
08/10/2022 Letter INSPECTION SUMMARY

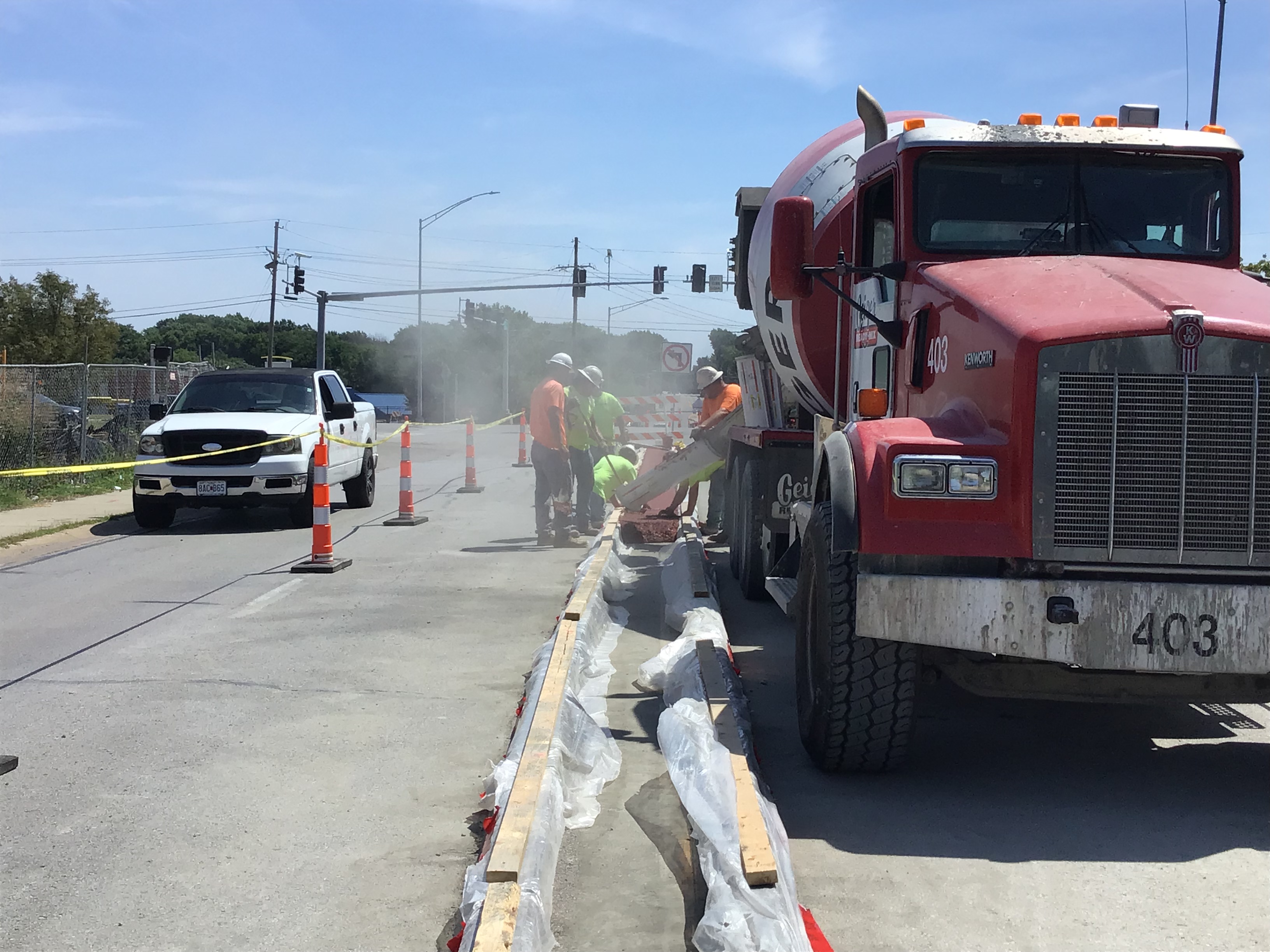

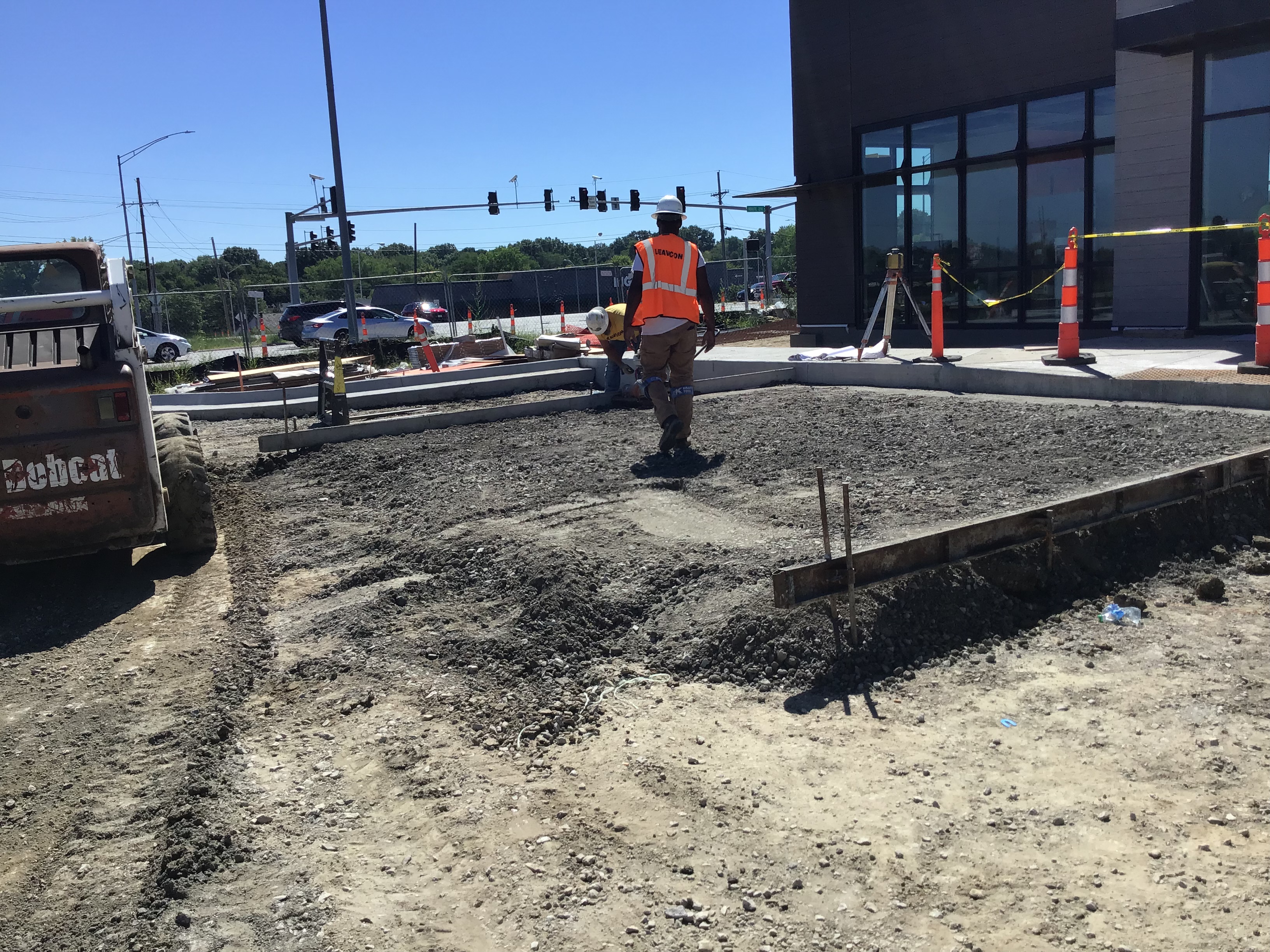

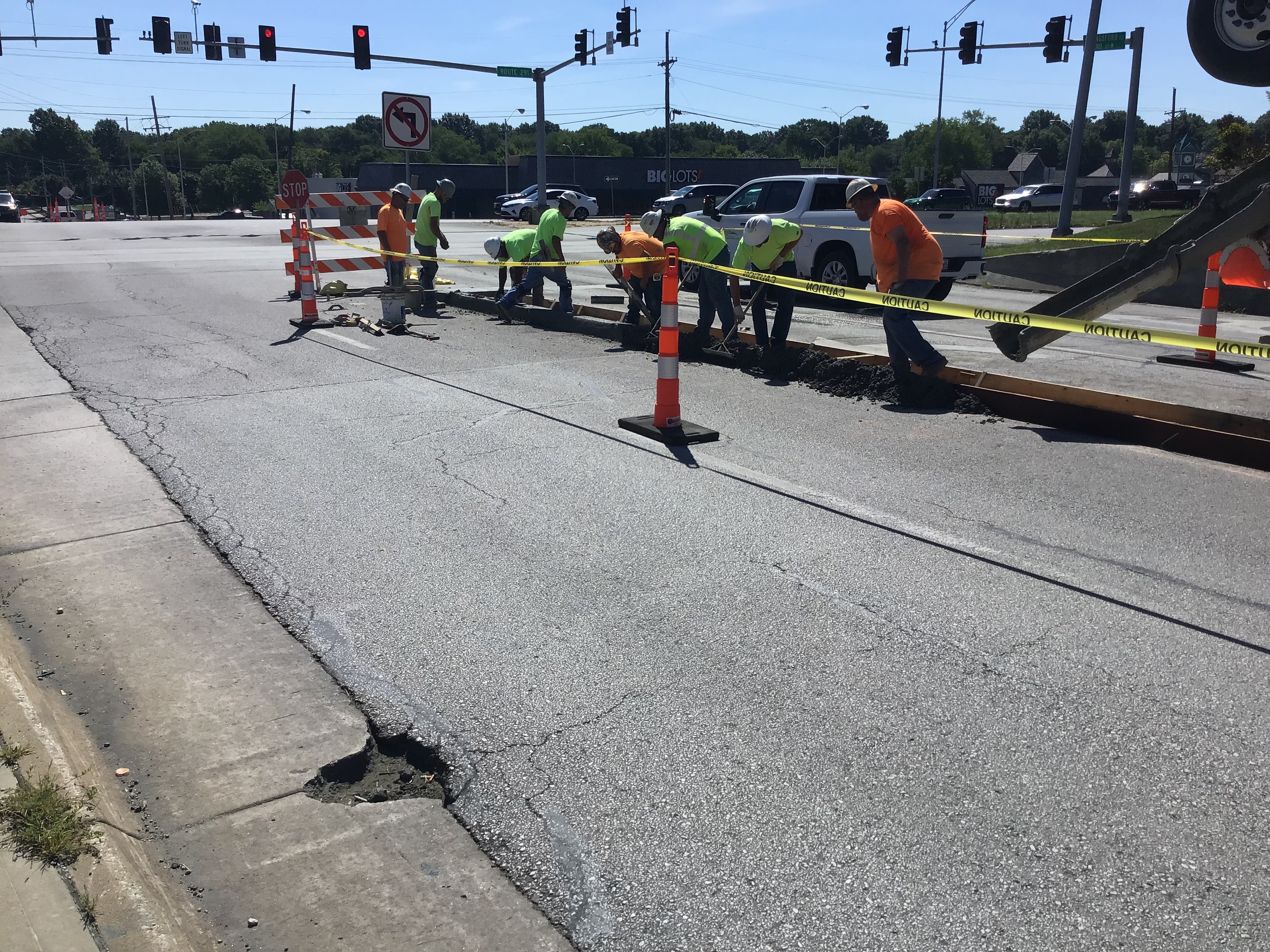

08/11/2022 Street Median Const 1 pic
08/11/2022 Street Median Const 2 pic
08/11/2022 street Median Const 3 pic
08/11/2022 Street Median Const 4
08/11/2022 Street Median Const 5
08/11/2022 Street Median Const 6
08/11/2022 Letter INSPECTION SUMMARY
05/16/2022 Letter INSPECTION SUMMARY
08/11/2022 Letter INSPECTION SUMMARY

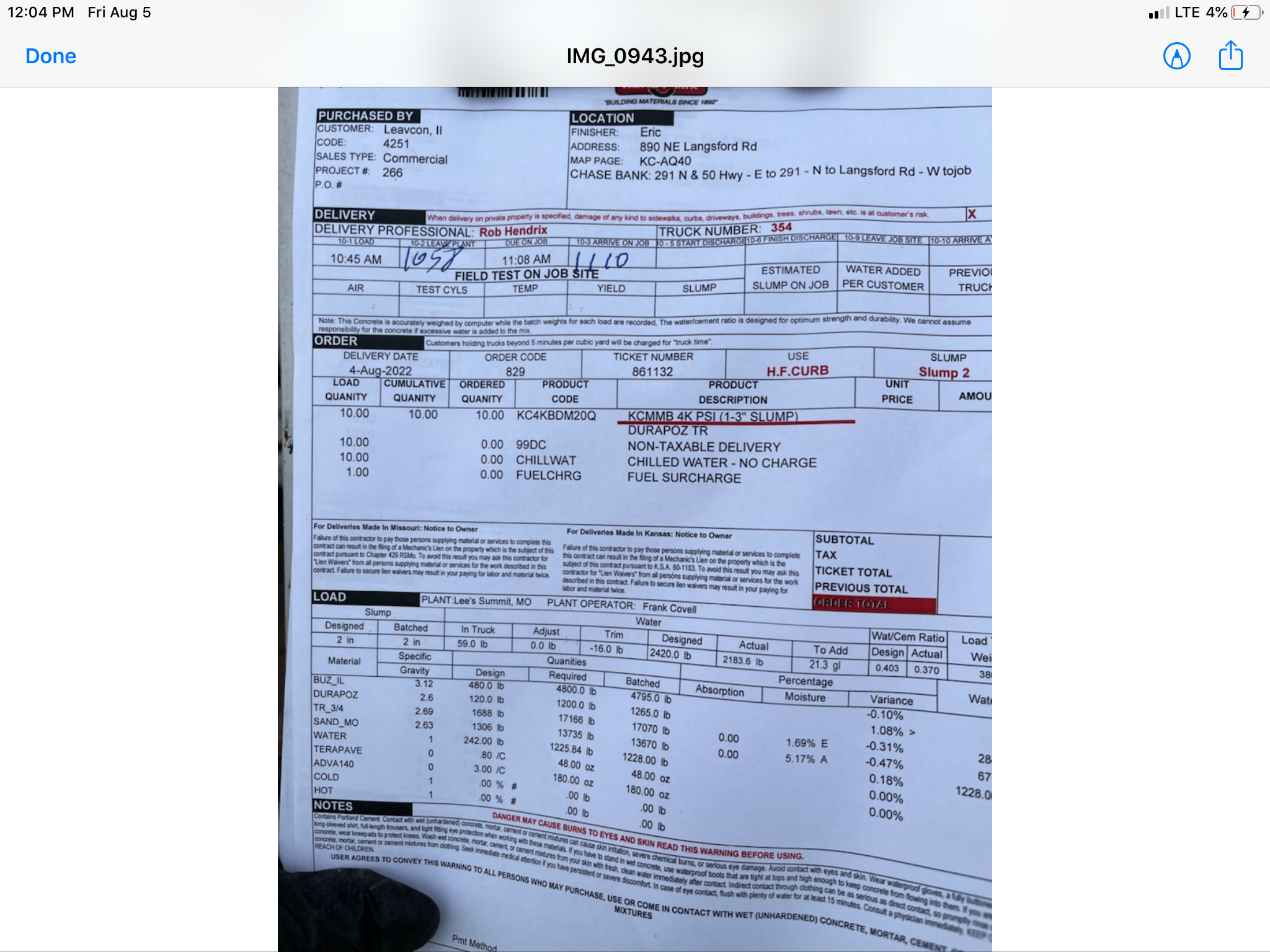

08/12/2022 Ticket for red stamped concrete

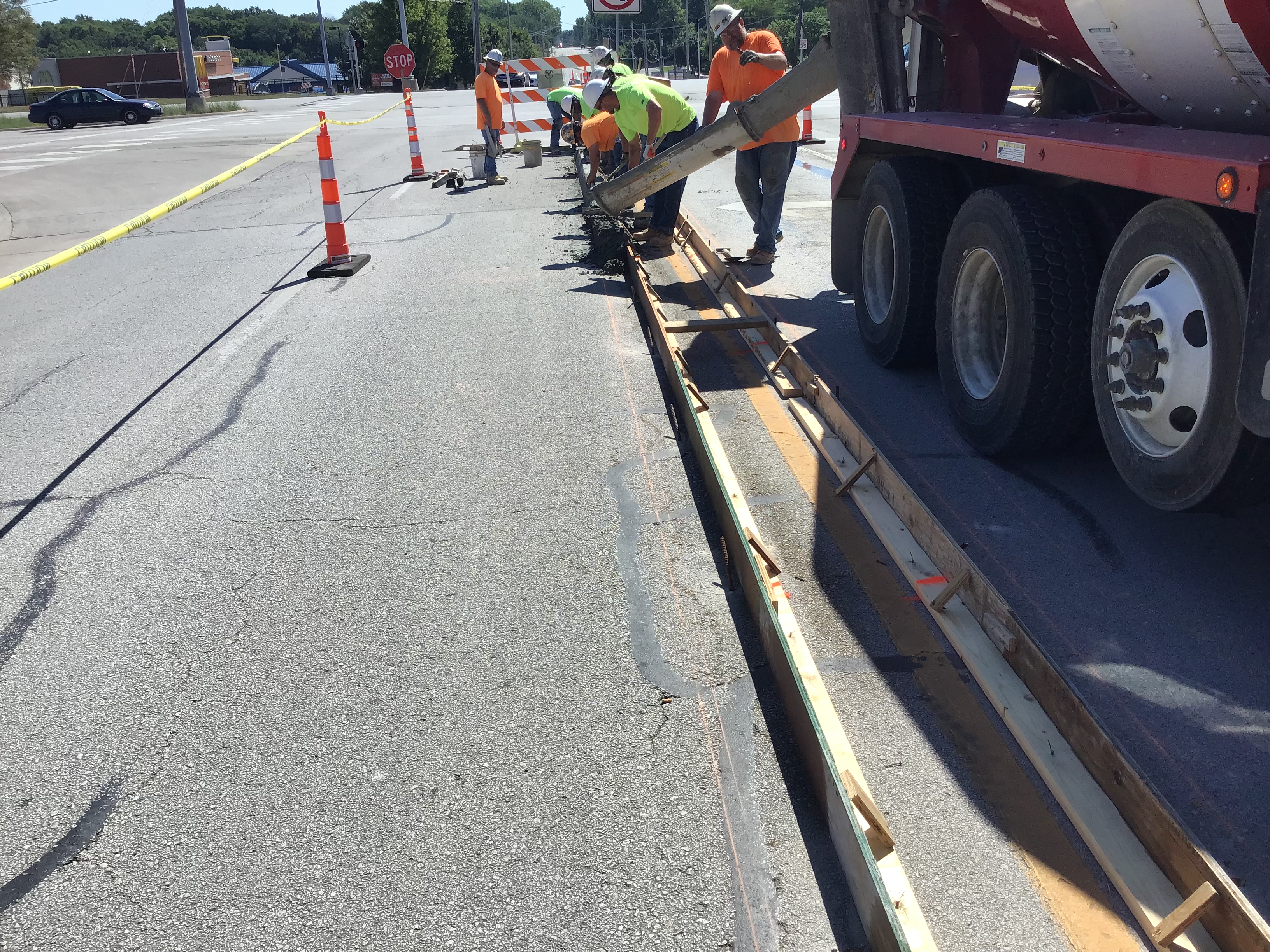

08/12/2022 Red dye concrete pour
08/12/2022 Letter INSPECTION SUMMARY
08/15/2022 Removal of Sidewalk
08/15/2022 Removal of Sidewalk0
08/15/2022 Letter INSPECTION SUMMARY
08/17/2022 Letter INSPECTION SUMMARY

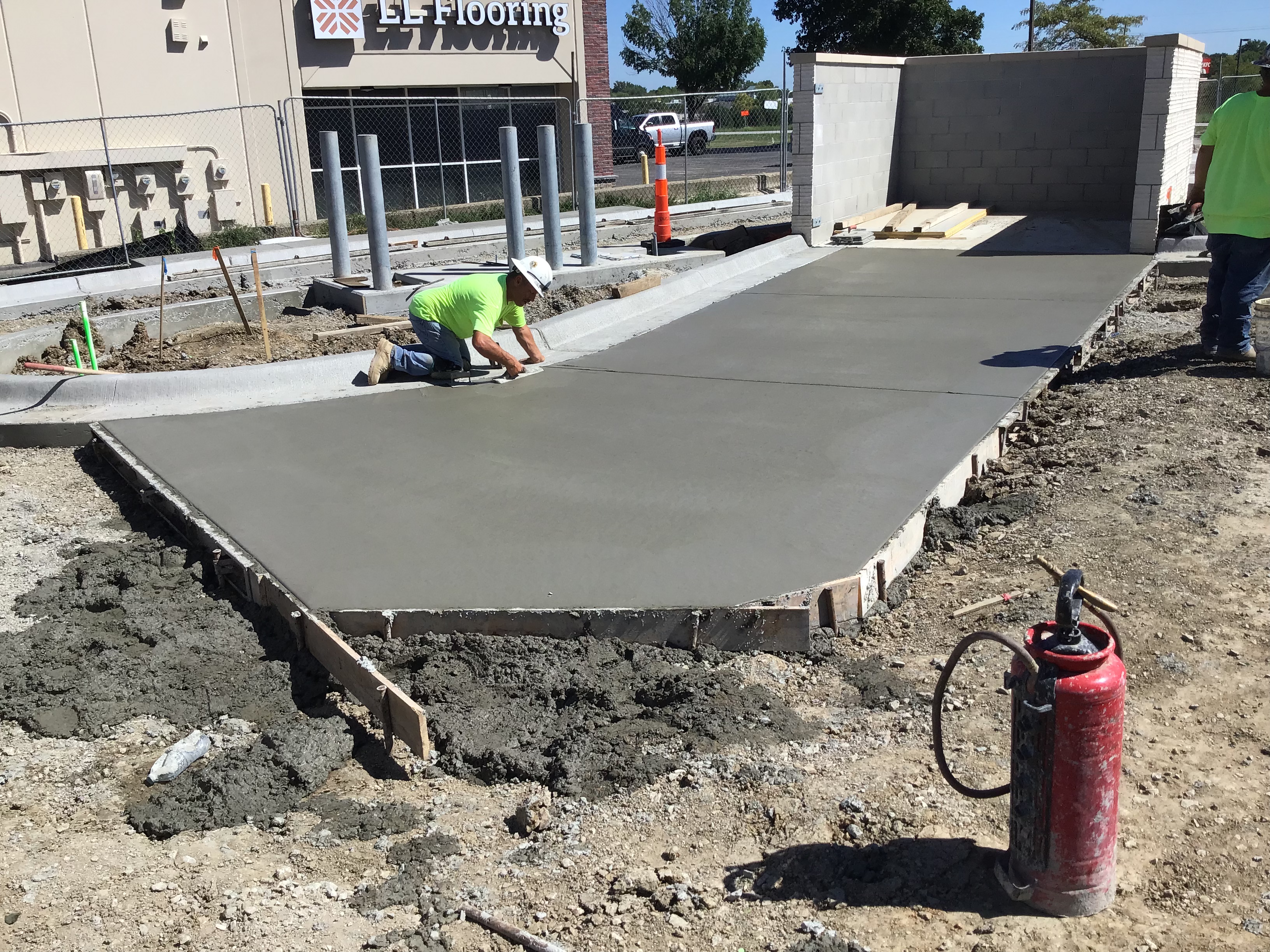

08/18/2022 Northside Sidewalk connected to building 1
08/18/2022 Northside Sidewalk connected to building 2
08/18/2022 Northside Sidewalk connected to building 3
08/18/2022 Letter INSPECTION SUMMARY
08/19/2022 Letter INSPECTION SUMMARY

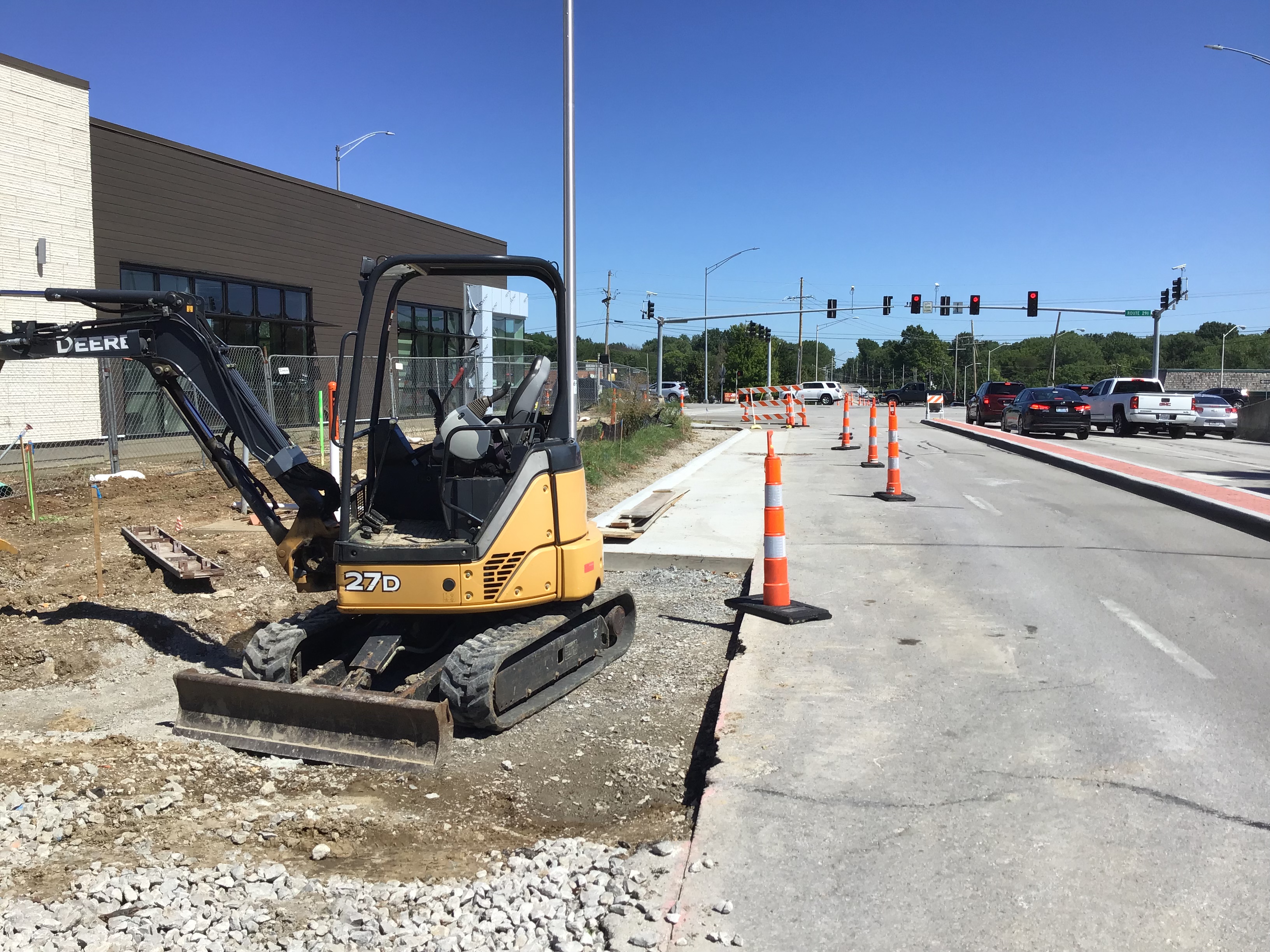

08/22/2022 Curbs in Parking Lot 1
08/22/2022 Curbs in Parking Lot 2

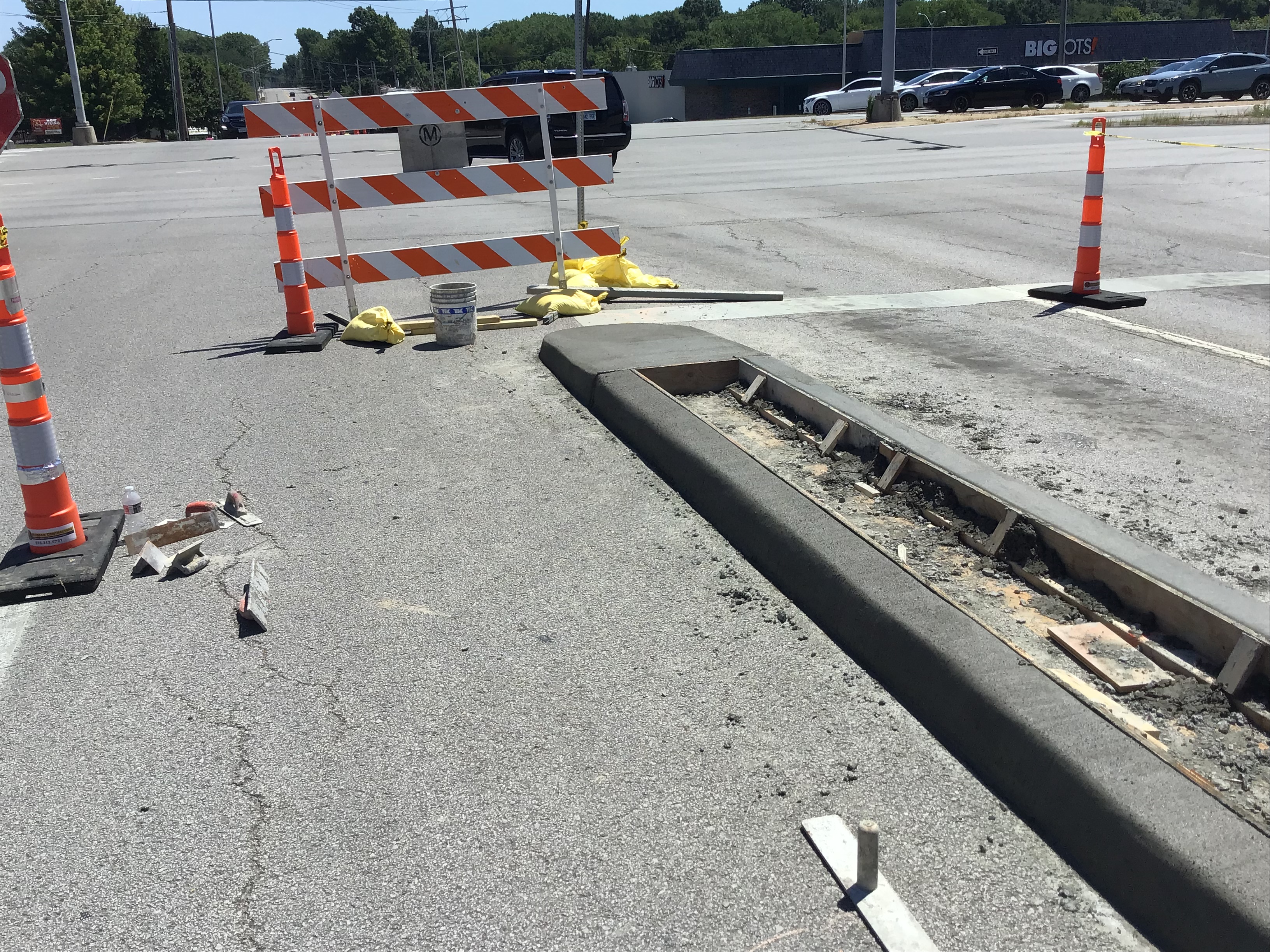

08/22/2022 Letter INSPECTION SUMMARY

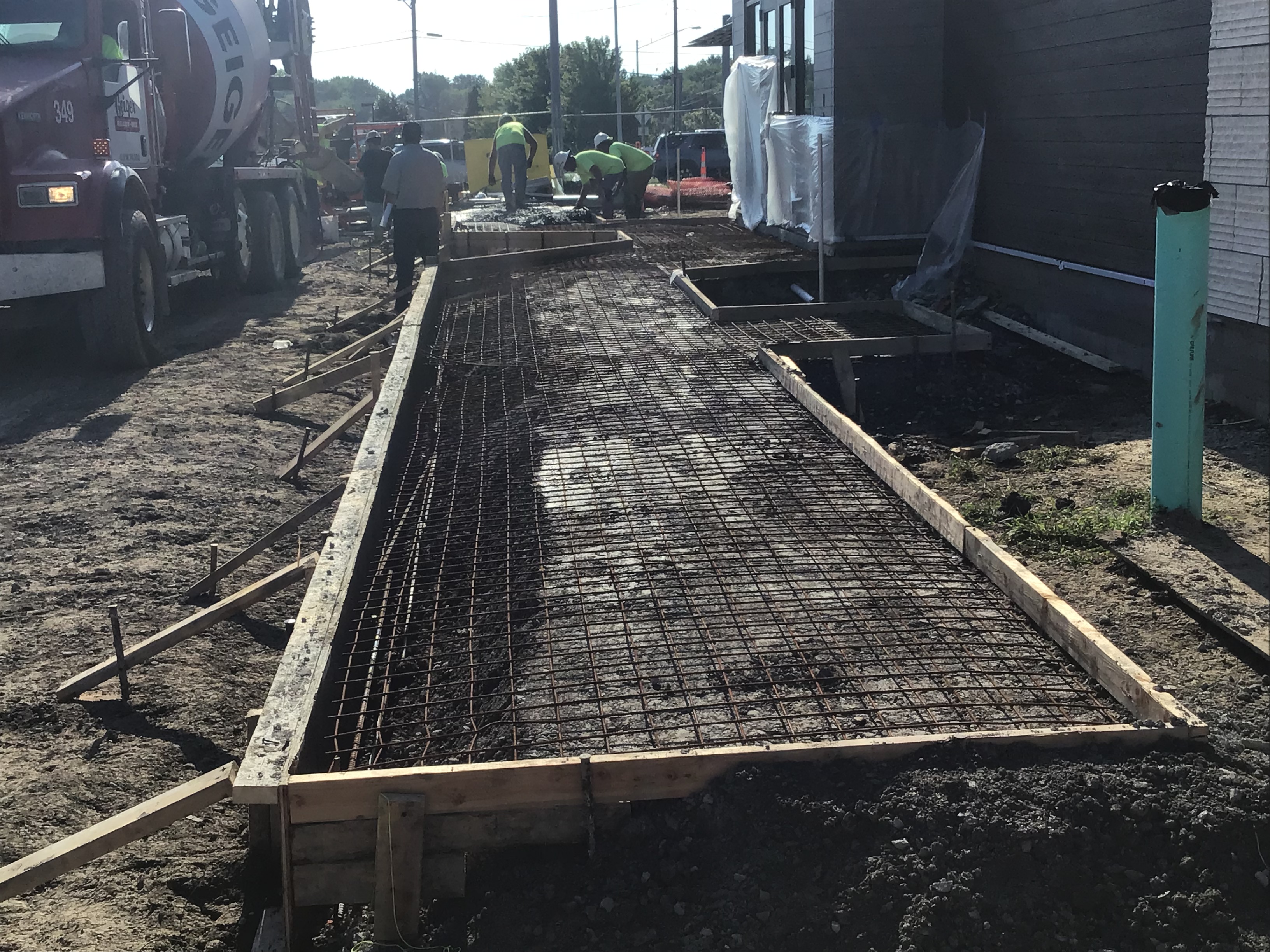

08/22/2022 Sidewalk 1
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY

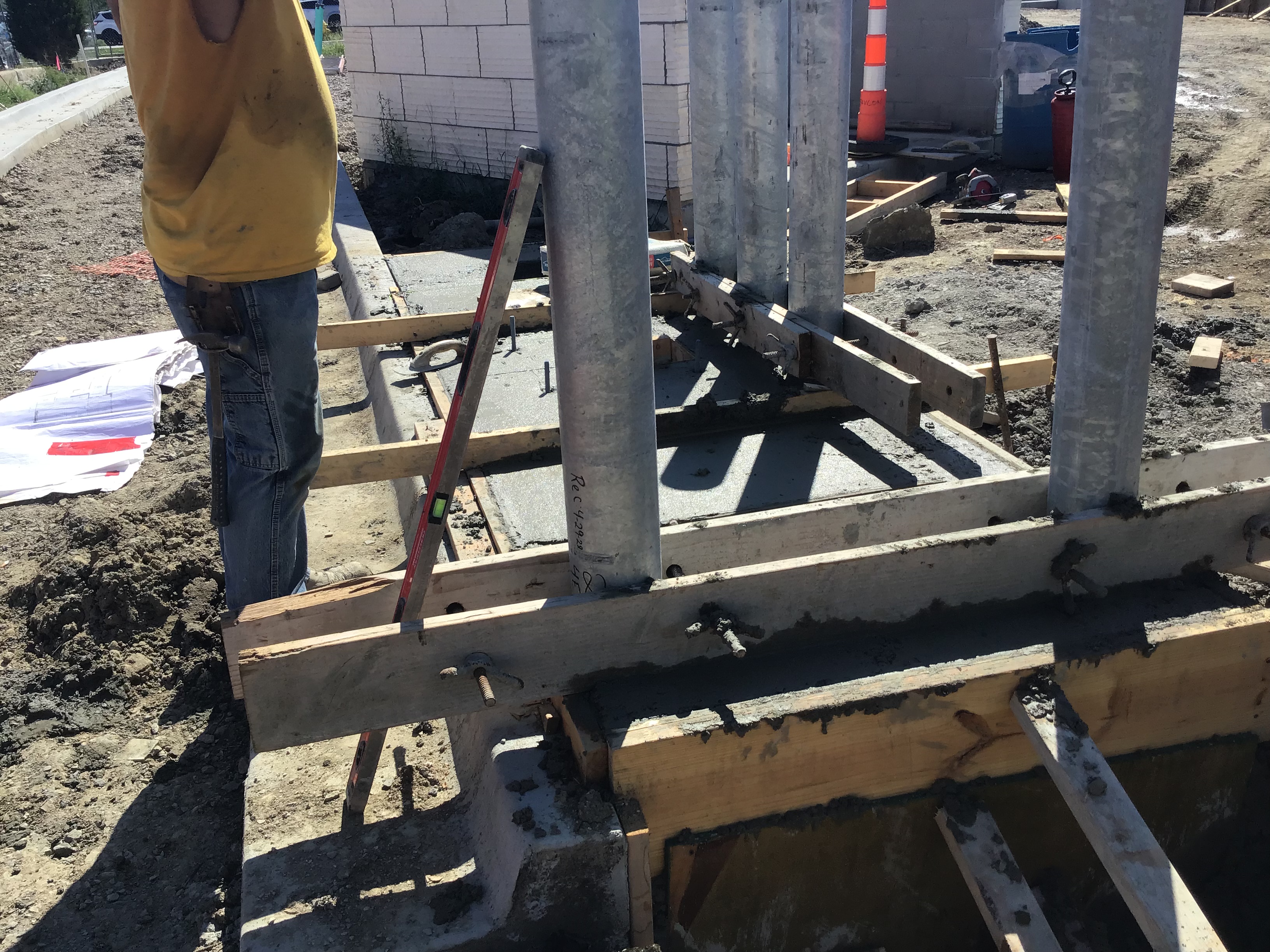

08/23/2022 Base of ATM
08/23/2022 Letter INSPECTION SUMMARY
08/26/2022 Letter INSPECTION SUMMARY

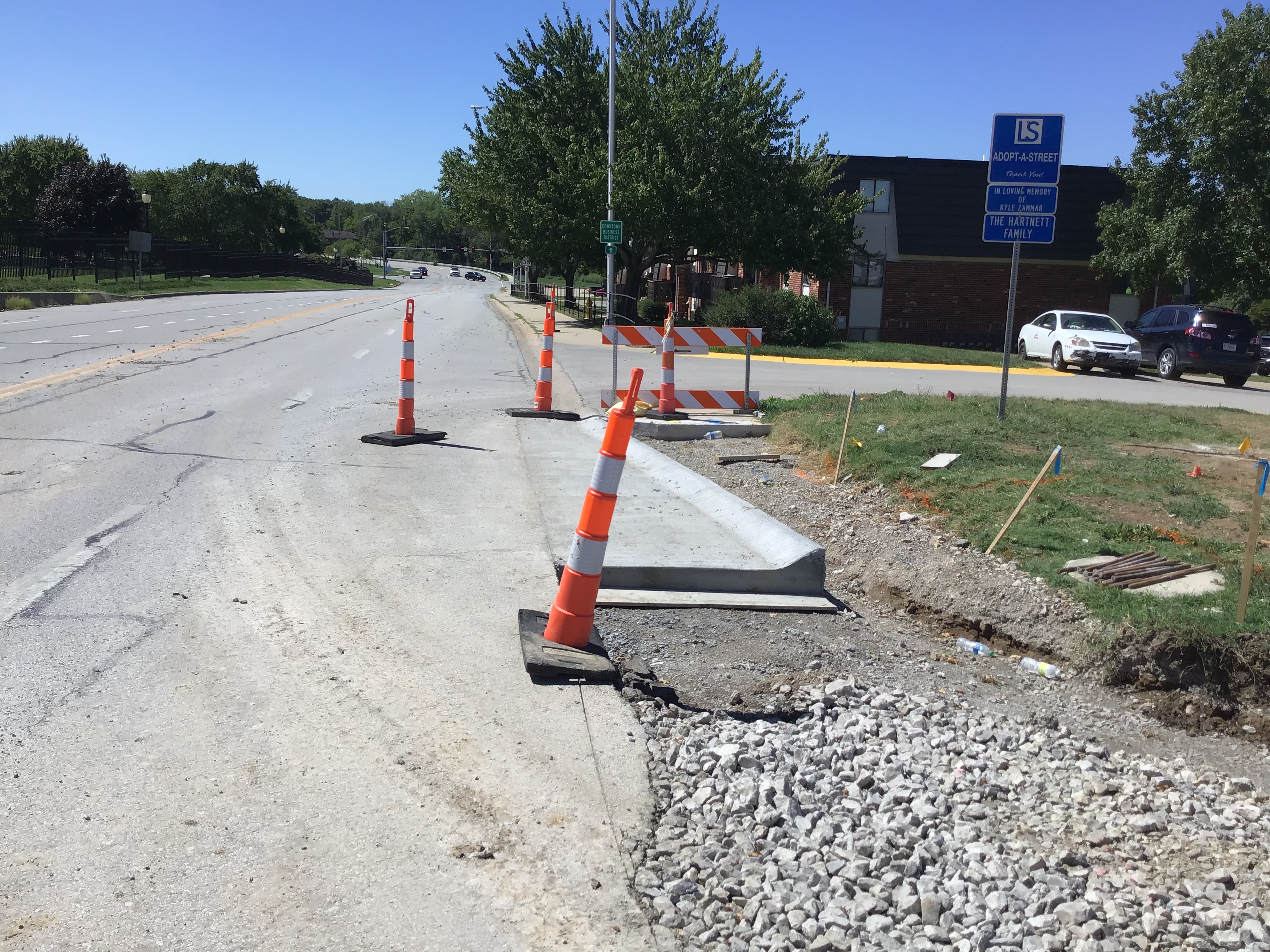

08/26/2022 Curbs along Langsford RD 1
08/26/2022 Curbs along Langsford RD 2
08/26/2022 Letter INSPECTION SUMMARY
08/30/2022 Curbs along Langsford Road 2
08/30/2022 Curbs along Langsford Road 1
08/30/2022 Letter INSPECTION SUMMARY
08/31/2022 Sidewalk Forms & Materials along Langsford
08/31/2022 Handicap Parking Area
08/31/2022 Concrete Pad for Dumpster Poured
08/31/2022 Letter INSPECTION SUMMARY
08/31/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Sidewalk 2
09/07/2022 Sidewalk 3
09/07/2022 Letter INSPECTION SUMMARY
09/13/2022 Letter INSPECTION SUMMARY
09/14/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter Fire Loss Reduction Form
09/19/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter INSPECTION SUMMARY
09/19/2022 Letter INSPECTION SUMMARY
09/20/2022 ADR_03533627-53_rev_1
09/20/2022 CTR_03533627-14-C1_rev_2
09/20/2022 CTR_03533627-16-C1_rev_2
09/20/2022 CTR_03533627-18-C1_rev_2
09/20/2022 CTR_03533627-20-C1_rev_2
09/20/2022 CTR_03533627-22-C1_rev_2
09/20/2022 CTR_03533627-23-C1_rev_2
09/20/2022 CTR_03533627-25-C1_rev_4
09/20/2022 CTR_03533627-30-C1_rev_2
09/20/2022 CTR_03533627-31-C1_rev_2
09/20/2022 CTR_03533627-32-C1_rev_2
09/20/2022 CTR_03533627-35-C1_rev_2
09/20/2022 CTR_03533627-36-C1_rev_2
09/20/2022 CTR_03533627-38-C1_rev_2
09/20/2022 CTR_03533627-41-C1_rev_2
09/20/2022 CTR_03533627-42-C1_rev_3
09/20/2022 CTR_03533627-44-C2_rev_1
09/20/2022 CTR_03533627-45-C1_rev_1
09/20/2022 CTR_03533627-46-C1_rev_1
09/20/2022 CTR_03533627-47-C1_rev_1
09/20/2022 CTR_03533627-51-C1_rev_1
09/20/2022 CTR_03533627-52-C1_rev_1
09/20/2022 CTR_03533627-53-C1_rev_1
09/20/2022 CTR_03533627-56-C1_rev_5
09/20/2022 CTR_03533627-58-C1_rev_1
09/20/2022 FC_03533627-14_rev_1
09/20/2022 FC_03533627-16_rev_1
09/20/2022 FC_03533627-18_rev_1
09/20/2022 FC_03533627-20_rev_1
09/20/2022 FC_03533627-22_rev_1
09/20/2022 FC_03533627-23_rev_1
09/20/2022 FC_03533627-25_rev_1
09/20/2022 FC_03533627-30_rev_1
09/20/2022 FC_03533627-31_rev_1
09/20/2022 FC_03533627-32_rev_1
09/20/2022 FC_03533627-35_rev_1
09/20/2022 FC_03533627-36_rev_1
09/20/2022 FC_03533627-38_rev_1
09/20/2022 FC_03533627-41_rev_1
09/20/2022 FC_03533627-44_rev_1
09/20/2022 FC_03533627-45_rev_1
09/20/2022 FC_03533627-46_rev_1
09/20/2022 FC_03533627-47_rev_1
09/20/2022 FC_03533627-51_rev_1
09/20/2022 FC_03533627-52_rev_1
09/20/2022 FC_03533627-53_rev_1
09/20/2022 FC_03533627-56_rev_1
09/20/2022 FC_03533627-58_rev_1
09/20/2022 FC_03533627-59_rev_1
09/20/2022 FDR_03533627-13_rev_1
09/20/2022 FDR_03533627-50_rev_1
09/20/2022 FRL_03533627-13_rev_1
09/20/2022 FRL_03533627-18_rev_1
09/20/2022 FRL_03533627-22_rev_1
09/20/2022 PRR_03533627-54_rev_1
09/20/2022 RSI_03533627-13_rev_1
09/20/2022 RSI_03533627-16_rev_1
09/20/2022 RSI_03533627-18_rev_1
09/20/2022 RSI_03533627-20_rev_1
09/20/2022 RSI_03533627-22_rev_1
09/20/2022 RSI_03533627-23_rev_1
09/20/2022 SDFR_03533627-15_rev_1
09/20/2022 SDFR_03533627-17_rev_1
09/20/2022 SDFR_03533627-19_rev_1
09/20/2022 SDFR_03533627-21_rev_1
09/20/2022 SDFR_03533627-24_rev_1
09/20/2022 SDFR_03533627-42_rev_1
09/20/2022 Letter INSPECTION SUMMARY
09/20/2022 Letter Inspection Summary
09/21/2022 Letter Fire Loss Reduction Form
09/21/2022 Letter INSPECTION SUMMARY
09/21/2022 CB Lees summit_ Back flow test
09/21/2022 Receipt Receipt for transaction:2022-007718
09/21/2022 Letter Codes Temporary Certificate of Occupancy
09/29/2022 North ATM foundation CTR_03533627-45-C1_rev_2
09/29/2022 Chase hwy 291Median Changes
09/29/2022 Plans As-built plans for public street improvements
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/18/2022 Security Document Chase Bank Lee's Summit - ROW COST BREAKDOWN
10/24/2022 Activity Document CofLS Final Affidavit and Agreement - Chase Bank 291
10/24/2022 Certificate/License Codes Temporary Certificate of Occupancy
10/24/2022 Receipt Receipt for transaction: 2022-008467
10/26/2022 Security Document Chase Bank Maintenance Bond
10/27/2022 3RD Party Insp Report Backflow Test Reports
10/27/2022 Photograph ATM/Canopy Footing
10/27/2022 Letter INSPECTION SUMMARY
11/03/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/18/2022 Letter CBLS_ Extension Request Form_ 11.18.2022
11/18/2022 Certificate/License Codes Temporary Certificate of Occupancy
11/18/2022 Receipt Receipt for transaction:2022-009034
11/22/2022 Letter Field Certificate of Occupancy
11/22/2022 Letter Codes Final Certificate of Occupancy
12/20/2023 Letter Codes Temporary Certificate of Occupancy39
06/27/2025 Letter PW ROW Inspections Report
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
