Permit Application Status

PRSUBD20211958


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20211958
Public Infrastructure
Final Acceptance
HUNT MIDWEST REAL ESTATE DEV INC
DEVELOPMENT COMPLETE
FULL PUBLIC INFRASTRUCTURE FOR RESIDENTIAL SUBDIVISION
04/22/2021
10/05/2021
07/25/2023
Locations
Address
2107 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2111 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2115 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2119 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2123 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2127 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2131 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2135 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2139 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2143 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2147 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2203 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2207 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2211 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2215 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2219 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2210 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2206 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2202 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2630 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2626 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2622 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2618 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2614 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2610 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2602 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2506 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2502 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2503 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2144 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2137 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2607 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2611 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2615 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2619 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2623 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2627 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2631 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2635 SW TRACKER LN, LEES SUMMIT, MO 64082

Address
2136 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2626 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2622 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2618 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2614 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2610 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2606 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2133 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2136 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2132 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2128 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2124 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2120 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2116 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2112 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2108 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2103 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2107 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2111 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2121 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2125 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2129 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2603 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2607 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2611 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2615 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2619 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2623 SW FIREFLY LN, LEES SUMMIT, MO 64082

Address
2116 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2618 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2614 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2610 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2606 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2607 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2611 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2615 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2619 SW BARLEY FIELD DR, LEES SUMMIT, MO 64082

Address
2110 SW HOOK FARM DR, LEES SUMMIT, MO 64082

Address
2140 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Address
2606 SW TRACKER LN, LEES SUMMIT, MO 64082

Property
268429

Property
268430

Property
268431

Property
268432

Property
268433

Property
268434

Property
268435

Property
268436

Property
268437

Property
268438

Property
268439

Property
268440

Property
268441

Property
268442

Property
268443

Property
268444

Property
268445

Property
268446

Property
268447

Property
268448

Property
268449

Property
268450

Property
268451

Property
268452

Property
268453

Property
268454

Property
268455

Property
268456

Property
268457

Property
268458

Property
268459

Property
268460

Property
268461

Property
268462

Property
268463

Property
268464

Property
268465

Property
268466

Property
268467

Property
268468

Property
268469

Property
268470

Property
268471

Property
268472

Property
268473

Property
268474

Property
268475

Property
268476

Property
268477

Property
268478

Property
268479

Property
268480

Property
268481

Property
268482

Property
268483

Property
268484

Property
268485

Property
268486

Property
268487

Property
268488

Property
268489

Property
268490

Property
268491

Property
268492

Property
268493

Property
268494

Property
268495

Property
268496

Property
268497

Property
268498

Property
268499

Property
268500

Property
268501

Property
268502

Property
268503

Property
268504

Property
268505

Property
268506

Property
268507

Property
268508

Address
2104 SW WHEATFIELD DR, LEES SUMMIT, MO 64082

Contacts
HUNT MIDWEST REAL ESTATE DEV INC, Address:8300 UNDERGROUND DR STE 200
OLSSON ASSOCIATES, Address:1301 BURLINGTON, SUITE 100, Phone:(816) 361-1171
Reviews
Review Type Outcome Est. Completion Date Completed
Master Draingage As-built Review Approved 10/18/2022 10/18/2022
Steve Robbins
Licensed Contractors Approved 04/22/2021 10/05/2021
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 09/22/2021
91100C8-Sanitary Sewer Insp Fees $6,834.31 $6,834.31 Paid 09/22/2021
91100C9-Water Insp Fee $8,600.62 $8,600.62 Paid 09/22/2021
9110072-Water Test Fee $1,000.00 $1,000.00 Paid 09/22/2021
9110068-Storm Fee $10,253.66 $10,253.66 Paid 09/22/2021
9110081-Paved Surface Inspection Fee $12,297.41 $12,297.41 Paid 09/22/2021
9110071-Site Grading Fee $29,546.22 $29,546.22 Paid 09/22/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Site Visit Complete 11/29/2021 11/30/2021
Misc
Informational
11/30/2021
Make a site visit due to concerns that the contractor was working out of the boundaries of the property being developed. Checked with Diana Johnson and she was confident they were were not out of the boundaries of their permit. Erosion control devices are in place as they are using silt fence and mulch berms throughout the site. Contractor said police has been out to talk to them due to a complaint about where they are working. After going over the plans they seem to be working where they are allowed to according to the permit that has been issued.
Misc
Informational
02/11/2022
On Friday 2.11.2022 Randy Spalding Excavation was on site grading at various locations throughout the project site.
Sidewalk Inspection Passed 12/22/2021
Sanitary Sewer Construction Inspection Passed 02/01/2022
Misc
Informational
11/05/2021
11/5/2021 Contractor raised existing manholes MH 1-3, MH 1-4, MH 1-5, MH 1-6 and MH 1-7. On Monday 12/6/2021 Contractor, Redford Construction cored existing MH 1-4 to begin installing sanitary pipe(8-inch SDR 26 PVC sewer pipe) On Tuesday 12/07/2021 Contractor, Redford Consruction installed 171 LF of 8-inch SDR 26 sanitary pipe and MH 1-1 On 12.08.2021 Wednesday Contractor installed MH 1-2 was installed and 224 LF of sanitary pipe. On 12.09.2021 Thursday Contractor installed 11 laterals and MH 1-3 On 12.10.2021 Friday Contractor is backfilling the sanitary lines 2 and 3 On Monday 12.13.2021 Contractor installed 3 service laterals on Line 1 between MH 1-3 and MH 1-4. Construction began on Line 2 sanitary sewer. 12.16.2021 Thursday Contractor, Redford Construction installed MH 2-1 and three laterals. On Wednesday, 12-22-2021. Redford resumes sewer laterals for line 2. Redford installed laterals north and south of the main sewer from MH 1-3, 2-1 and 2-3. Contractor Redford wets project site to keep down the dust down and back fills some of the laterals on the main.
Misc
Informational
12/21/2021
On Monday, 12-20-2021. Redford Excavating resumed Sanitary Sewer installation. Contractor layer approx 80 LF of 8” Sewer pipe and placed (1) lateral for lot 112. Contractor hit rock and it has slowed installation of sewer. On Tuesday, 12-21-2021. Contractor resumed Sanitary Installation for line 2. Approx 100 LF of 8” pipe was placed and (3) laterals where installed as well. Contractor is watering down fill materials to back fill with. On Thursday, 12-23-2021. Redford Excavation resumed Sanitary Sewer back filling for laterals previously placed. Contractor watered down Shell back fill for proper moisture compaction. Contractor also reinstalled (1) Man Hole riser and lid that had been disturbed.
Misc
Informational
01/03/2022
On Monday, 1-3-2022. Redford Excavating resumed Sanitary Sewer installation. I, Tom Taylor was off on Christmas Holiday’s from 12-24-2021 to Monday the 12-28-2021. On Tuesday I was not in due to what I thought was a chest cold. On Wednesday, 12-29- 2021. I returned to work . The contractor worked to install Line 4. The contractor installed MH 4-1 and approx 120 LF of 8” PVC pipe. In Late afternoon I was asked to not return to work for the next day until I could show a negative Covid test result. On Thursday I received a COVID test and was found to have contracted the virus. The contractor completed line #4 while I was out including all laterals and back filled. On Wednesday, 1-05-2021, I returned with a negative test result. The contractor Redford had began installation of line #1. Contractor connected to the existing MH #1-7 and installed 171 LF of 8” pvc pipe. Contractor also installed MH 1 - 1 and approx 120 LF of 8” pvc sewer pipe.
Misc
Informational
01/10/2022
On Monday, 1-3-2022. Redford Excavating resumed Sanitary Sewer installation. On Monday 1.10.2021contractor is installing Line 4 and 5 laterals.
Misc
Informational
01/11/2022
On Monday, 1-3-2022. Redford Excavating resumed Sanitary Sewer installation. On Monday 1.10.2021 contractor is installing Line 4 and 5 laterals. On Tuesday 1.11.2021 Contractor is installing sanitary sewer line 4 and laterals
Misc
Informational
01/12/2022
On Monday, 1-3-2022. Redford Excavating resumed Sanitary Sewer installation. On Monday 1.10.2022 contractor is installing Line 4 and 5 laterals. On Tuesday 1.11.2022 Contractor is installing sanitary sewer line 4 and laterals On Wednesday 1.12.2022 Contractor installed MH 4-2 and set 2 laterals. Contractor back filled sanitary Line 4.
Erosion Control Inspection Failed 02/08/2022
Misc
Informational
02/08/2022
Erosion Control Failed
Storm Sewer Construction Inspection Passed 02/22/2022
Misc
Informational
01/19/2022
On 1-17-2022 Monday Redford installed storm boxes CI 1-2, CI 1-3, CI 1-4, CI 1-6, CI 1-7, and CI 1-8. No inverts were poured. On 1-18-2022 Tuesday Storm boxes CI 1-2, CI 1-3, CI 1-4, CI 1-6, CI 1-7, and CI 1-8 concrete collars were poured. Storm boxes CI 5-1, CI 5-2, FI 2-3, FI 2-1, and CI 2-2 were installed On 1-19-2022. Wednesday CI 1-3, CI 4-1, CI 4-2 and CI 6-1 were installed. Field inlets 6-2 and 6-3 were installed but contractor did not pour collars or inverts. On 1-20-2022 Thursday Pipe collars were poured. Inverts were poured for field inlets and storm boxes CI 2-6, FI 6-3, CI 6-1, CI 2-5, and FI 6-2. On 1-21-2022 Friday Redford worked 1/2 day. Backfilled installed pipelines 1.24.2022 Monday Installed with pipe collars and inverts for Lines 1 and 3 1.25.2022 Tuesday installed CI 3-1, CI 4-2, CI 4-1, and FI 2-3 1-26-2022 Wednesday Backfilled storm lines 2, 4, 5 1.27.28 Thursday Backfilled storm lines 6. 1.28.2022 Contractor did not work. 1-31-2022 Monday Poured for 3 pipe collars and 3 storm box inverts. On 2.1.2022 Backfilled all open excavations in anticipation of snow storm this week. On Wednesday 2.2.2022 a big snow storm hit and the contractor, Redford told me they would not return until Monday 2.7.2022. On Monday 2.7.2022 Redford construction resumed working. Boxes for Line 8 were delivered. CI 8-2 and CI 8-3 were installed. CI 6-1 was set but no invert or pipe collar was poured. On Tuesday 2.8.2022 Storm boxes CI 8-3, CI 8-4, and CI 9-2 were installed and collars and inverts were poured. On 2.9.2022 Wednesday Storm boxes CI 8-2, CI 8-3, CI 8-4, and CI 8-5 are installed. Concrete Pipe collars and inverts are done. Line 7 is complete only CI 7-1 on that line. Storm boxes CI 9-2 and CI 9-3 installed. Contractor is waiting to receive FI 9-4. On 2.10.2022 Thursday FI 9-4 was set. Inverts were poured for CI 4-1, CI 4-2. Storm box tops were set for all curb inlets and field inlets Line 1 thru 9. Grading was done in various locations throughout the project site. On 2.11.2022 Randy Spalding graded in various locations throughout the project site. On 2.14.2022 Redford Construction installed CI 10-2, CI 10-3, and FI 10-4. Pipe collars and inverts were poured for CI 10-3 and FI 10-4. On 2.15.2022 Redford Construction set CI 11-1 and CI 11-2 and pipe collars poured. On Wednesday 2.16.2022 Storm Line #12 installed CI 12-1 invert and pipe collar poured. (Last storm line). Backfilling and setting storm box tops. On 2.25.2022 Added a stack piece to storm box 6-1 to bring it to grade. On 3.14.2022 Monday Contractor installed 150 LF of storm pipe 8-2 to End Section 8-1.
Water Line - Construction Inspection Partial 03/08/2022
Misc
Informational
02/22/2022

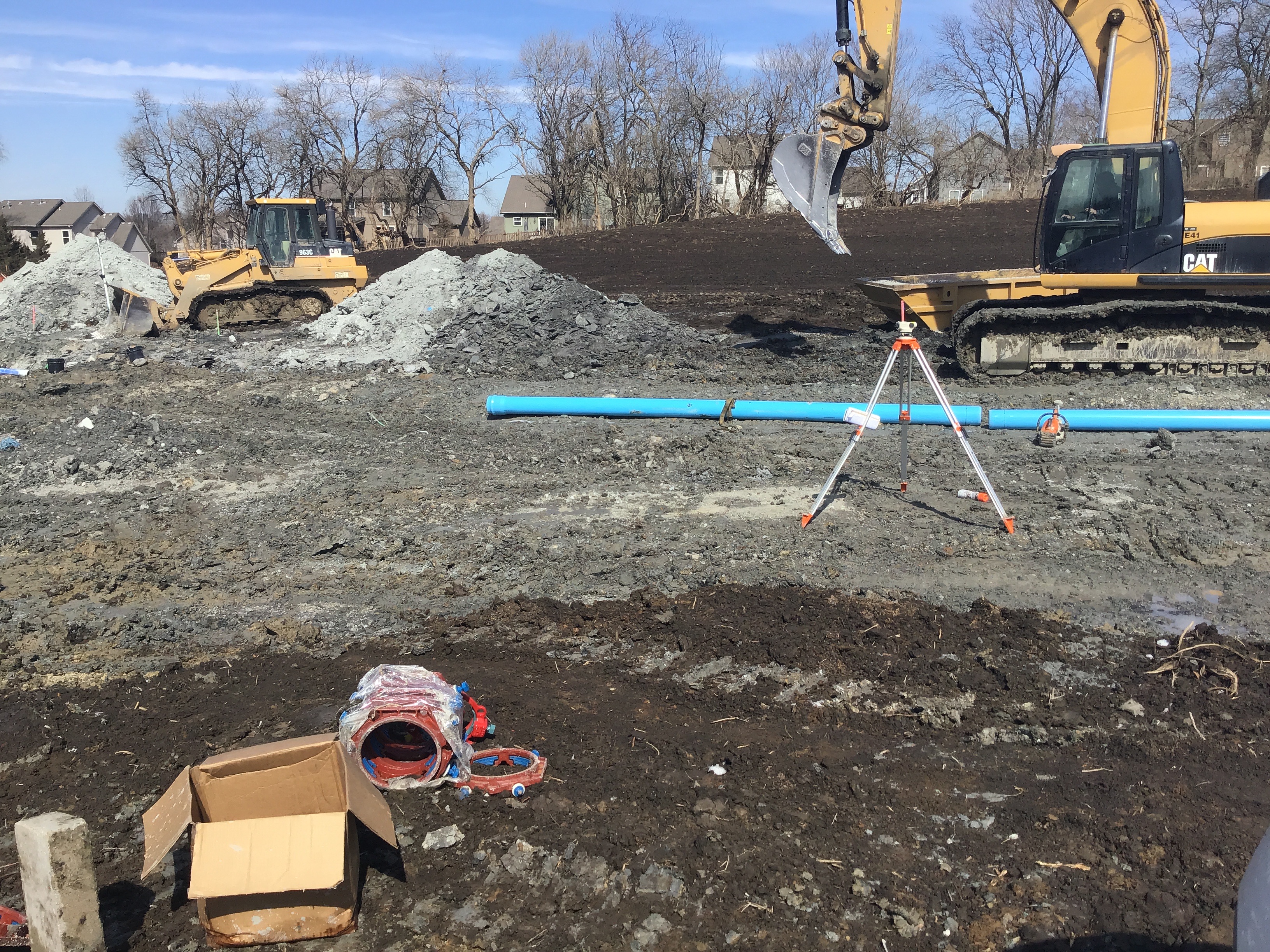

On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
03/03/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite. On Wednesday March 9, 2022 Water line #1 tie-in to existing waterline Plat #1. Extremely muddy conditions. On 3.14.2022 Water line #3 was installed and 80 ft of Line #1 installed. Remaining water line #4 was completed. Concrete thrust blocks have not been installed yet. Muddy conditions. On 3.15.2022 All Waterline thrust blocks were poured. On 3.16.2022 Waterlines were flushed On 3.21.2022 I Requested WU to install construction taps in waterlines for water testing. On 3.22.2022 No Activity today due to Rain.
Sanitary Sewer - Air Test Passed 03/18/2022
Misc
Informational
03/04/2022
On 2.28.2022 the following manholes passed the pressure test: MH 1-1, 1-2, 1-3 and MH 4-1 and 4-2 On 3.1.2022 the following manholes passed the test: MH 1-4, 3-1, 3-2 and 2-1, 2-2
Sanitary Sewer - Vacuum Passed 03/18/2022
Misc
Informational
03/03/2022
On 2.28.2022 the following manholes passed vacuum test MH 4-1 MH 4-2 MH 1-1 MH 1-2 On 3.1.2022 the following manholes passed the vacuum test: MH 1-4 MH 3-1 MH 3-2 MH 2-2 On 3.4.2022 the following manholes passed the vacuum test: MH 2-1 MH 3-1 On 3.17.2022 The following manholes passed the vacuum test: MH 1- 3
Sanitary Sewer - Mandrel Passed 03/18/2022
Misc
Informational
03/14/2022
On 3.4.2022 Line 1, 2,3, and 4 passed the Mandrel test.
Water Line - Construction Inspection Failed 03/24/2022
Misc
Informational
03/08/2022
On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
03/08/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite.
Misc
Corrective Action Required
03/24/2022
All visible valve boxes appear to be constructed with SDR26 pipe, these are not to spec per our current design and construction manual and will need to be replaced(section 6900 section G page 9 linked below). 3/24/22 ES https://cityofls.net/Portals/0/Files/Development/Regulations%20and%20Policies/Design%20and%20Construction%20Manual/2020%20Final/LS%20Sec%206900%20July%202020.pdf?ver=2020-09-25-132202-013
Water Line - Construction Inspection Partial 03/28/2022
Misc
Informational
03/24/2022
On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
03/24/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite.
Misc
Corrective Action Required
03/24/2022
All visible valve boxes appear to be constructed with SDR26 pipe, these are not to spec per our current design and construction manual and will need to be replaced(section 6900 section G page 9 linked below). 3/24/22 ES https://cityofls.net/Portals/0/Files/Development/Regulations%20and%20Policies/Design%20and%20Construction%20Manual/2020%20Final/LS%20Sec%206900%20July%202020.pdf?ver=2020-09-25-132202-013
Misc
Informational
03/28/2022
Water installed 5 of 8 construction taps. Contacted Patrick to let him know the 3 that were not able to be installed(NE and NW corner connections and SW cul de sac). Once the tap holes are excavated water can install remaining taps. 3/28/22 ES
Water Line - Hydrostatic Test Passed 04/04/2022
Misc
Informational
04/01/2022
On 4/1/2022 Redford Construction conducted pressure testing Line 1 indicated a leak and testing was halted to locate and fix the leaking. Testing resume today and passed the pressure test. Held @ 160 lbs for 2 hours.
Water Line - Construction Inspection Partial 3/29/2022 3/29/2022 04/05/2022
Misc
Informational
03/28/2022
On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
03/28/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite.
Misc
Corrective Action Required
03/28/2022
All visible valve boxes appear to be constructed with SDR26 pipe, these are not to spec per our current design and construction manual and will need to be replaced(section 6900 section G page 9 linked below). 3/24/22 ES https://cityofls.net/Portals/0/Files/Development/Regulations%20and%20Policies/Design%20and%20Construction%20Manual/2020%20Final/LS%20Sec%206900%20July%202020.pdf?ver=2020-09-25-132202-013
Misc
Informational
03/28/2022
Water installed 5 of 8 construction taps. Contacted Patrick to let him know the 3 that were not able to be installed(NE and NW corner connections and SW cul de sac). Once the tap holes are excavated water can install remaining taps. 3/28/22 ES
Misc
Informational
04/05/2022
Daniel with Redford dechlorinated the water line today. They are still short the far SW tap as the hole still has water in it. They are wanting to do samples first thing in the morning. 4/5/22 ES
Grading/Excavation/Fill Inspection Partial 04/11/2022
Misc
Informational
11/02/2021
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site.
Misc
Informational
11/03/2021
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site.
Misc
Informational
11/05/2021
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site. 11/5/2021 Contractor raised existing manholes MH 1-3, MH 1-4, MH 1-5, MH 1-6,MH. 1-7
Misc
Informational
11/10/2021
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site. 11/5/2021 Contractor raised existing manholes MH 1-3, MH 1-4, MH 1-5, MH 1-6,MH. 1-7 On Wednesday 11/10/2021 The contractor is mass grading in various locations throughout the site.
Misc
Informational
11/16/2021
On Tuesday 11/16/2021 The contractor, Randy Spalding is mass grading in various locations throughout the site. On Thursday 11/18/2021 The contractor is mass grading in various locations throughout the site. On Tuesday 11/23/2021 Spalding Excavating began filling in SW Wheatfield Court street mass grading throughout the site. On Wednesday 11/24/2021 Spalding Excavating is mass grading in various locations throughout the project site. On Monday 11/29/2021 Contractor, Spalding Excavating, Inc. is mass grading in various locations throughout the project site. On Thursday 12/2/2021 the Contractor is mass grading in various locations throughout the project site From 12.06.2021 to 12.10.2021 Contractor, Randy Spalding, is mass grading throughout the project site. On 2.23.2021 Randy Spalding Excavating was cleaning up spoils(dirt left over from laying pipe) and spreading top soil throughout the project. On 2.24.2022 Contractor is conducting mass grading throughout the project site. On 3.9.2022 Contractor has stopped grading and is mobilizing equipment to move to another project.
Misc
Informational
04/11/2022
4-11-22 AN crew is doing some grading for some of the lots at the back of the plat
Water Line - Construction Inspection Partial 04/11/2022
Misc
Informational
04/05/2022
On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
04/05/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite.
Misc
Corrective Action Required
04/05/2022
All visible valve boxes appear to be constructed with SDR26 pipe, these are not to spec per our current design and construction manual and will need to be replaced(section 6900 section G page 9 linked below). 3/24/22 ES https://cityofls.net/Portals/0/Files/Development/Regulations%20and%20Policies/Design%20and%20Construction%20Manual/2020%20Final/LS%20Sec%206900%20July%202020.pdf?ver=2020-09-25-132202-013
Misc
Informational
04/05/2022
Water installed 5 of 8 construction taps. Contacted Patrick to let him know the 3 that were not able to be installed(NE and NW corner connections and SW cul de sac). Once the tap holes are excavated water can install remaining taps. 3/28/22 ES
Misc
Informational
04/05/2022
Daniel with Redford dechlorinated the water line today. They are still short the far SW tap as the hole still has water in it. They are wanting to do samples first thing in the morning. 4/5/22 ES
Misc
Informational
04/11/2022
4-11-22 AN spoke with contractor and we looked at mapper and there should not be anyone effected when the do the water tie-in
Water Line - Coliform Test 1 Passed 4/6/2022 (8:00) 4/6/2022 04/13/2022
Misc
Informational
04/04/2022
On Monday 4.4.2022 Redford Construction began chlorination of the water pipe lines On Wednesday 4.6.2022 Redford collected 1st Water Samples 7 samples were collected and taken to Keystone Labs On Thursday 4.7.2022 Redford collected 2nd Water samples 7 samples were collected and taken to Keystone Labs.
Pavement-Curb Construction Partial 04/20/2022
Misc
Informational
04/20/2022
JK concrete was on-site prepping for curb installation. 4/20/22 ES On 4.27.2022 JK Concrete installed 250 yards of concrete for curb placement(approx. 5,000 LF of curb). 4.29.2022 JK Concrete were clearing out rock from curb inlets to prepare for pouring concrete inlet throats. Several inlet throats were poured on SW Hook Drive. 5.3.2022 JK Concrete were pouring curb inlet throats when SR issued a stop work because the project site is too wet and compaction is too poor. Another proof roll will be required before asphalt can be placed. 5.9.2022 Monday JK Concrete finished curb construction and poured curb inlet throat for 4 boxes. On Tuesday 5.10.2022 JK Concrete poured curb inlet throats on SW Firefly Lane
Misc
Informational
05/10/2022
On 5.10.2022 Spalding was grading throughout the site and backfilling curbs throughout the site. JK Construction installed 10 curb inlet throats. 5.11.2022 JK Construction completed curb inlet throat construction. Spalding was backfilling curbs and grading the project site.
Site Visit Partial 04/20/2022
Misc
Informational
04/20/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES
Misc
Informational
05/27/2022
On 5.27.2022 Redford Construction lowered MH 1-6 by removing two manhole rings and adding a 6-inch riser. And grouting concrete around the box top for CI 7-1.
Misc
Informational
07/13/2022
On 7.13.2022 JK Concrete installed handicap ramps throughout project site. SW Tracker Lane & SW Hook Farm Drive SW Hook Farm Drive & SW Firefly Lane SW Hook Farm Drive & SW Barley Drive Cul-de-sac @ SW Hook Farm Drive DJ 7.15.2022 JK Concrete installed H/C ramps SW Farmhouse Road & SW Tracker Lane SW Wheatfield Court & SW Tracker Lane SW Barley Field Drive & SW Wheatfield Court DJ
Sanitary Sewer - Camera Test Partial 3/3/2022 04/28/2022
Pavement-Aggregate Base Partial 05/12/2022
Misc
Informational
05/12/2022
Spalding is grading the subgrade aggregate preparing for asphalt. They are also backfilling behind the curbs.
Misc
Informational
05/18/2022
On 5.17.2022 Tuesday Superior Bowen laid 2,102 tons of base APWA Type 5 R 30% asphalt. On 5/18/2022 Wednesday Superior Bowen was drying puddles throughout the site. On 5/19/2022 Thursday Superior Bowen laid 501 tons of APWA Type 5 R 30% asphalt. On 5/20/2022 Friday Superior Bowen laid 1,513 tons of surface asphalt.
Pavement-Aggregate Base Partial 05/12/2022
Misc
Informational
05/12/2022
Spalding is grading the subgrade aggregate preparing for asphalt. They are also backfilling behind the curbs.
Misc
Informational
05/12/2022
Splaying grading the subgrade base getting ready fir a proof roll tomorrow at 2pm May 12
Pavement-Aggregate Base Partial 05/13/2022
Misc
Informational
05/12/2022
Spalding is grading the subgrade aggregate preparing for asphalt. They are also backfilling behind the curbs.
Misc
Informational
05/12/2022
Spalding grading the subgrade base getting ready fir a proof roll tomorrow at 2pm May 12
Misc
Informational
05/13/2022
Redford is adjusting the sewer lids to grade. Spalding is continuing to work on the aggregate preparing for a proofroll this afternoon.
Pavement-Proof Roll Passed 05/13/2022
ADA Inspection Partial 07/18/2022
Misc
Informational
07/18/2022
7-18-22 RH. All ADA ramps poured so far that have followed the ADA and LS Specification.
Site Visit Partial 07/19/2022
Misc
Informational
04/20/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM.
Erosion Control Inspection Partial 07/26/2022
Misc
Informational
02/08/2022
Erosion Control Failed
Misc
Corrective Action Required
07/26/2022
7.26.2022 Replace all gutter buddies
Sanitary Sewer - Camera Test Passed 5/31/2022 07/29/2022
Erosion Control Inspection Failed 08/08/2022
Misc
Informational
07/26/2022
Erosion Control Failed
Misc
Corrective Action Required
07/26/2022
7.26.2022 Replace all gutter buddies
Misc
Corrective Action Required
08/08/2022
8.8.2022 Replace all inlet protection devices.
ESC - (Vegetation/Ground Cover) Failed 8/17/2022 8/17/2022 08/17/2022
Misc
Informational
07/13/2022
8.17.2022 There is no inlet protection
Site Visit Partial 08/23/2022
Misc
Informational
07/19/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM. 8-22-22 RH. No work on site for development.
Site Visit Partial 08/24/2022
Misc
Informational
08/23/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM. 8-22-22 RH. No work on site for development. 8-24-22 RH. No work on site for development.
Site Visit Partial 08/25/2022
Misc
Informational
08/24/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM. 8-22-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-25-22 RH. No work for development today.
Erosion Control Inspection Failed 08/29/2022
Misc
Informational
08/08/2022
Erosion Control Failed
Misc
Corrective Action Required
08/08/2022
7.26.2022 Replace all gutter buddies
Misc
Corrective Action Required
08/08/2022
8.8.2022 Replace all inlet protection devices. 8-29-22 RH. Storm Inlets need to be cleaned out. Some are starting to grow vegetation out of them.
Site Visit Partial 08/30/2022
Misc
Informational
08/25/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM. 8-22-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-25-22 RH. No work for development today. 8-30-22 RH. No work on site since 8-25-22.
Site Visit Partial 09/06/2022
Misc
Informational
08/30/2022
JK concrete was on-site prepping for curb installation. No other work being done. 4/20/22 ES 7-19-22 RH. No work for development services being completed in AM. 8-22-22 RH. No work on site for development. 8-24-22 RH. No work on site for development. 8-25-22 RH. No work for development today. 8-30-22 RH. No work on site since 8-25-22. 9-6-22 RH. No work on site since 8-30-22.
ADA Inspection Passed 10/18/2022
Misc
Informational
07/18/2022
7-18-22 RH. All ADA ramps poured so far that have followed the ADA and LS Specification.
Grading/Excavation/Fill Inspection Passed 10/18/2022
Misc
Informational
04/11/2022
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site.
Misc
Informational
04/11/2022
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site.
Misc
Informational
04/11/2022
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site. 11/5/2021 Contractor raised existing manholes MH 1-3, MH 1-4, MH 1-5, MH 1-6,MH. 1-7
Misc
Informational
04/11/2022
On 10/29/2021 The contractor, Randy Spalding Excavating, Inc. is mass grading in various locations throughout the site. 11/3/2021 All 5 sediment basins from plans are complete. Contractor, Randy Spalding, is mass grading in various locations throughout the site. 11/5/2021 Contractor raised existing manholes MH 1-3, MH 1-4, MH 1-5, MH 1-6,MH. 1-7 On Wednesday 11/10/2021 The contractor is mass grading in various locations throughout the site.
Misc
Informational
04/11/2022
On Tuesday 11/16/2021 The contractor, Randy Spalding is mass grading in various locations throughout the site. On Thursday 11/18/2021 The contractor is mass grading in various locations throughout the site. On Tuesday 11/23/2021 Spalding Excavating began filling in SW Wheatfield Court street mass grading throughout the site. On Wednesday 11/24/2021 Spalding Excavating is mass grading in various locations throughout the project site. On Monday 11/29/2021 Contractor, Spalding Excavating, Inc. is mass grading in various locations throughout the project site. On Thursday 12/2/2021 the Contractor is mass grading in various locations throughout the project site From 12.06.2021 to 12.10.2021 Contractor, Randy Spalding, is mass grading throughout the project site. On 2.23.2021 Randy Spalding Excavating was cleaning up spoils(dirt left over from laying pipe) and spreading top soil throughout the project. On 2.24.2022 Contractor is conducting mass grading throughout the project site. On 3.9.2022 Contractor has stopped grading and is mobilizing equipment to move to another project.
Misc
Informational
04/11/2022
4-11-22 AN crew is doing some grading for some of the lots at the back of the plat
Pavement-Aggregate Base Passed 10/18/2022
Misc
Informational
05/13/2022
Spalding is grading the subgrade aggregate preparing for asphalt. They are also backfilling behind the curbs.
Misc
Informational
05/13/2022
Spalding grading the subgrade base getting ready fir a proof roll tomorrow at 2pm May 12
Misc
Informational
05/13/2022
Redford is adjusting the sewer lids to grade. Spalding is continuing to work on the aggregate preparing for a proofroll this afternoon.
Pavement-Curb Construction Passed 10/18/2022
Misc
Informational
04/20/2022
JK concrete was on-site prepping for curb installation. 4/20/22 ES
Pavement-Proof Roll Passed 10/18/2022
Misc
Informational
04/18/2022
On Monday 4.18.2022 Use a 20.54 ton tandem truck Spalding and I completed a sub-grade proof roll for the placement of rock subgrade and it passed city standards. On Monday 4.25.2022 Randy Spalding used a 20.77 ton tandem truck to conduct a Curb proof roll which failed. Redford was onsite adjusting the curb boxes because of the rock placement for pavement. On Tuesday 4.26.2022 Spalding used a tandem truck to conduct a curb proof roll which passed with the exception of two soft areas which the contractor agreed to use the roller for more compression.
Pavement-Stabilized Subgrade Passed 10/18/2022
Misc
Informational
11/30/2021
4.7.2022 Spalding is preparing the roadway for soil stabilization. 4.14.2022 JK Spalding is placing chemical stabilization for pavement. String line for curb placement is in place.
Pavement-Surface Passed 10/18/2022
Misc
Informational
05/24/2022
On 5/20/2022 Friday Superior Bowen laid 1,513 tons of Type 6V surface asphalt.
Water Line - Construction Inspection Passed 10/18/2022
Misc
Informational
04/11/2022
On 2.21.2022 Redford Construction excavated and installed approximately 898.54 LF of 8-in C-900 pipe. (Line #1) On 2.22.2022 Line #1 was completed when approximately 334 LF of 6-inch pipe was installed. On 2.23.2022 Wednesday Redford didn’t work nor was there any construction today due to frigid temperatures (8 degrees F and wind chills -5 degrees F) On 2.24.2022 Thursday contractor didn’t work due to inclement weather (18 degrees F) On 2.25.2022 Friday Contractor installed Water Line #2 approximately 336 LF of 8-inch C900 pipe. On 2.28.2022 Monday Contractor installed approximately 650 LF of Water Line #2
Misc
Informational
04/11/2022
On 3.1.2022 Contractor, Redford Construction Installed approximately 650. LF of Water Line 5. Contractor began installing waterline #4 but encountered rock and switched to installing fire hydrants on installed lines On 3.2.2022 contractor installed approximately 500 LF of Water Line 2 On 3.3.2022 contractor dug out rock and installed installed water line #2 and poured thrust block on line #6. Thrust blocks were poured for Lines #1,2, one quarter of line #4, Line 5, and Line #6. Line #3 and three-fourths of Line #4 remain undone. On 3.4.2022. Contractor Backfilled waterlines #1,2,5,and 6 and graded the project site. John M. Jackson On 3.8.2022 Contractor continued work on water line # 4 installation.Contractor was breaking through rock, so progress is slow. Contractor was able to use acceptable backfill to cover water line. Conditions are extremely muddy onsite.
Misc
Corrective Action Required
04/11/2022
All visible valve boxes appear to be constructed with SDR26 pipe, these are not to spec per our current design and construction manual and will need to be replaced(section 6900 section G page 9 linked below). 3/24/22 ES https://cityofls.net/Portals/0/Files/Development/Regulations%20and%20Policies/Design%20and%20Construction%20Manual/2020%20Final/LS%20Sec%206900%20July%202020.pdf?ver=2020-09-25-132202-013
Misc
Informational
04/11/2022
Water installed 5 of 8 construction taps. Contacted Patrick to let him know the 3 that were not able to be installed(NE and NW corner connections and SW cul de sac). Once the tap holes are excavated water can install remaining taps. 3/28/22 ES
Misc
Informational
04/11/2022
Daniel with Redford dechlorinated the water line today. They are still short the far SW tap as the hole still has water in it. They are wanting to do samples first thing in the morning. 4/5/22 ES
Misc
Informational
04/11/2022
4-11-22 AN spoke with contractor and we looked at mapper and there should not be anyone effected when the do the water tie-in
Install Street and Stop Signs Passed 10/19/2022
Misc
Informational
10/19/2022
10-19-22 RH. Signs were all installed.
Record Drawing Review Passed 10/20/2022
Misc
Informational
10/20/2022
10-19-22 RH. Record drawings passed field inspection.

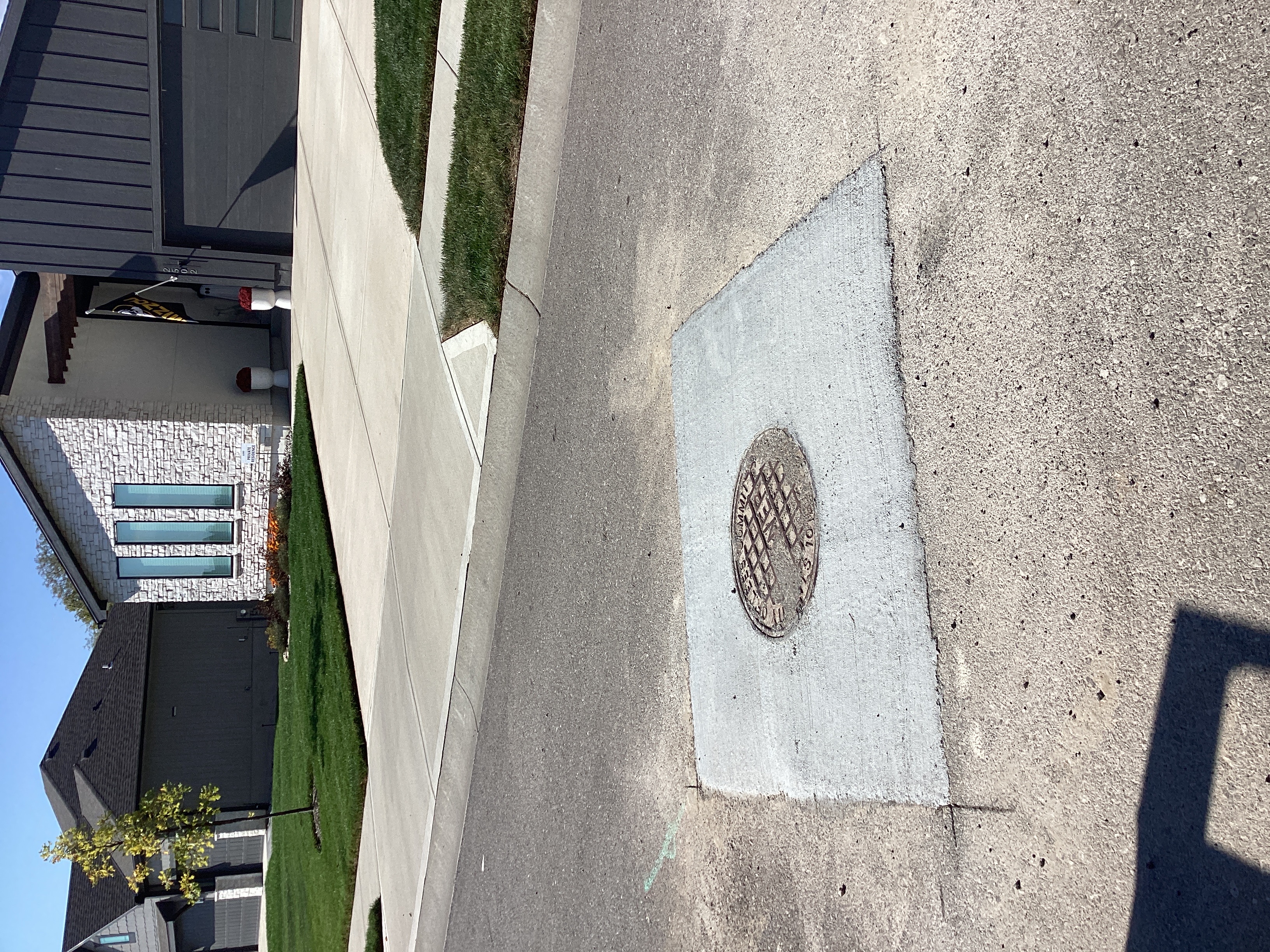

Master Drainage As-built Inspection Passed 10/20/2022 10/20/2022
Misc
Informational
10/20/2022
10-19-22 RH. Master Drainage passed inspection.
Erosion Control Inspection Partial 11/14/2022
Misc
Informational
08/29/2022
Erosion Control Failed
Misc
Corrective Action Required
08/29/2022
7.26.2022 Replace all gutter buddies
Misc
Corrective Action Required
08/29/2022
8.8.2022 Replace all inlet protection devices. 8-29-22 RH. Storm Inlets need to be cleaned out. Some are starting to grow vegetation out of them. 11-14-22 RH. Storm in lets still need to be cleaned out.
Documents & Images
Date Uploaded File Type Document Name
09/22/2021 Receipt Receipt for transaction:2021-007520
10/01/2021 Approved Plans Hook Farms 2nd - Site Disturbance Plans Approved 10.1.21
10/04/2021 Approved Plans Hook Farms 2nd Sanitary - Approved 10.4.21
10/04/2021 Approved Plans Hook Farms 2nd Street & Storm - Approved 10.4.21
10/05/2021 Letter DE-Permit
10/05/2021 Approved Plans Hook Farms 2nd Water Plans - Approved 10.5.21
11/30/2021 Letter INSPECTION SUMMARY
11/30/2021 Letter INSPECTION SUMMARY
12/21/2021 Letter INSPECTION SUMMARY
12/21/2021 Letter INSPECTION SUMMARY
12/22/2021 Letter INSPECTION SUMMARY
02/01/2022 Letter INSPECTION SUMMARY
02/08/2022 Letter INSPECTION SUMMARY
02/22/2022 Letter INSPECTION SUMMARY
02/28/2022 Letter INSPECTION SUMMARY
03/08/2022 image
03/08/2022 Letter INSPECTION SUMMARY
03/18/2022 Letter INSPECTION SUMMARY
03/18/2022 Letter INSPECTION SUMMARY
03/18/2022 Letter INSPECTION SUMMARY
03/23/2022 Letter INSPECTION SUMMARY
03/24/2022 Letter INSPECTION SUMMARY
03/28/2022 Letter INSPECTION SUMMARY
03/28/2022 Letter INSPECTION SUMMARY
04/04/2022 Letter INSPECTION SUMMARY
04/05/2022 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
04/11/2022 Letter INSPECTION SUMMARY
04/13/2022 Letter INSPECTION SUMMARY
04/13/2022 Passing Water Samples Hook Farms 2nd Plat
04/12/2022 Water Test #1 - passed
04/12/2022 Water Test #2 - passed
04/20/2022 Letter INSPECTION SUMMARY
04/20/2022 Letter INSPECTION SUMMARY
05/03/2022 Letter INSPECTION SUMMARY
05/03/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/12/2022 Letter INSPECTION SUMMARY
05/13/2022 Letter INSPECTION SUMMARY
05/13/2022 Letter INSPECTION SUMMARY
05/27/2022 Letter INSPECTION SUMMARY
06/01/2022 Letter INSPECTION SUMMARY
07/18/2022 Letter INSPECTION SUMMARY
07/19/2022 Letter INSPECTION SUMMARY
07/26/2022 Letter INSPECTION SUMMARY
08/23/2022 Letter INSPECTION SUMMARY
08/24/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/25/2022 Letter INSPECTION SUMMARY
08/29/2022 Letter INSPECTION SUMMARY
08/30/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
10/11/2022 Plans 2022_10_11_HookFarms2nd-MASTER DRAINAGE PLAN
10/11/2022 Plans 2022-10-11_HookFarms2ndSTREET & STORM
10/11/2022 Plans 2022-10-06_HookFarms2Sanitary
10/11/2022 Plans 22-10-11_HookFarms2nd_Water_Asbuilts
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY

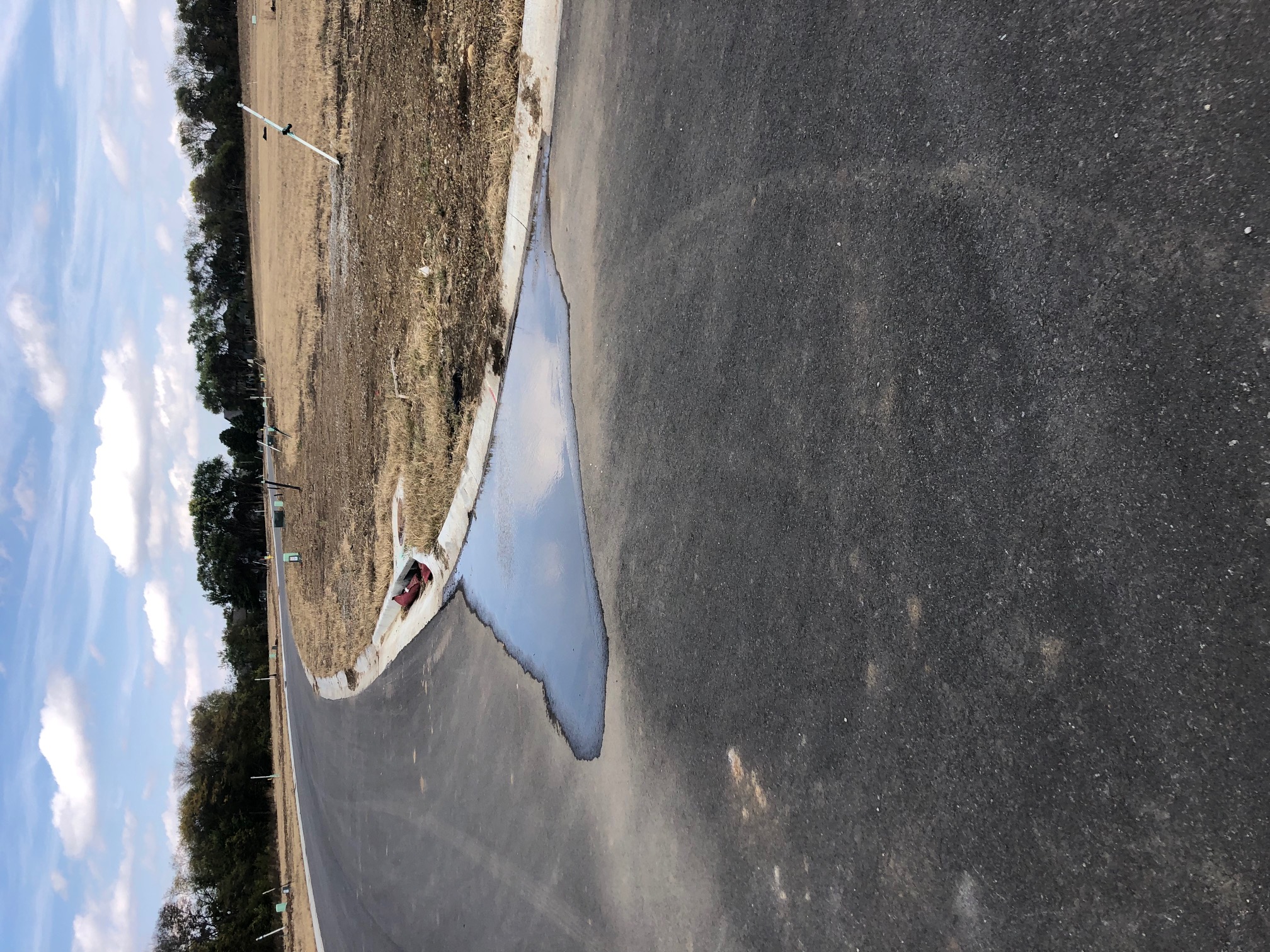

10/18/2022 Photograph Hook Farm 2nd Holding water

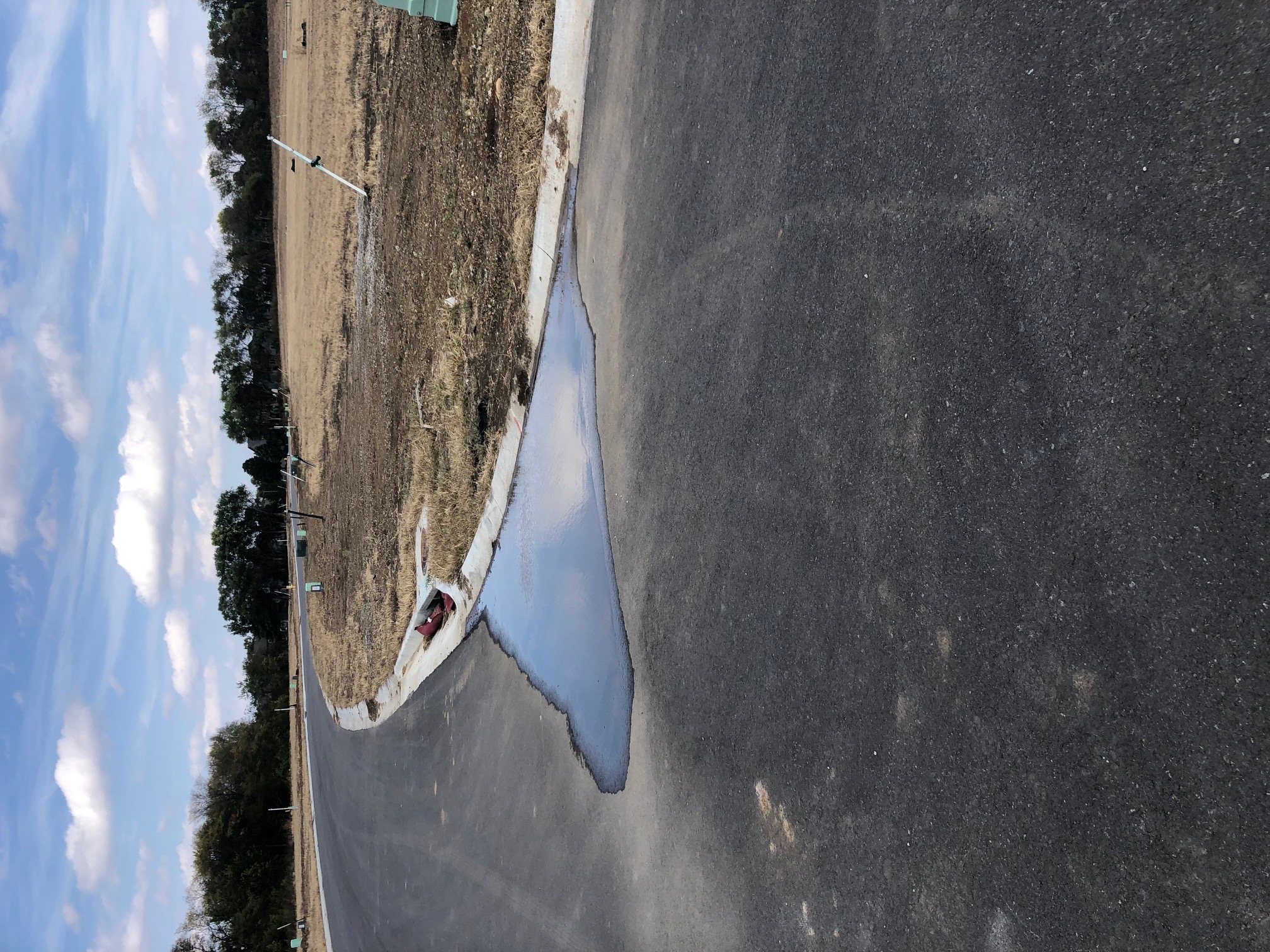

10/18/2022 Photograph Hook Farm 2nd -Holding Water 3
10/18/2022 Photograph Hook Farm 2nd -Holding Water 2
10/18/2022 Photograph Hook Farm 2nd -Holding Water 1
10/19/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
10/28/2022 Letter DE-Certificate of Substantial Completion Single Lot
10/28/2022 Letter DE-Punch List
10/28/2022 Letter Hook Farm 2nd Plat Substantial Completion
10/28/2022 Letter Hook Farm 2nd Plat Punch List
11/01/2022 Letter INSPECTION SUMMARY
11/04/2022 Letter INSPECTION SUMMARY
11/07/2022 Letter INSPECTION SUMMARY
11/08/2022 Letter Hook Farm 2nd Plat Udated Punch List
11/11/2022 Email FW_ Bond No_ 0250009 - Principal_ Hunt Midwest Real Estate Development_ Inc_ _EXTERNAL_
11/11/2022 Security Document Signed Maintenance Bond for Hook 2nd Plat
11/14/2022 Letter INSPECTION SUMMARY
11/14/2022 Letter INSPECTION SUMMARY
11/16/2022 Letter INSPECTION SUMMARY
12/14/2022 Activity Document Final Affidavit and Agreement Signed Hook 2nd Plat
07/25/2023 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
