Summary


PRSUBD20192722
Public Infrastructure
Final Acceptance
TOWNSEND SUMMIT LLC
DEVELOPMENT COMPLETE
Traffic control signal for Chipman Rd and Donovan Rd. Permit includes turn lane improvements, signal installation and electrical.
09/23/2019
10/04/2019
04/28/2023
05/28/2020
Locations
Contacts
TOWNSEND SUMMIT LLC, Address:1311 MCCORMICK RD STE 470, Phone:(303) 947-2044
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
JONATHAN MYERS, Address:EMERY SAPP
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 09/23/2019 09/23/2019
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110081-Paved Surface Inspection Fee $12,343.92 $12,343.92 Paid 09/25/2019
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 09/25/2019
9110079-After Hours Inspection (Building Codes)(Per Hour) $150.00 $150.00 Paid 04/23/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Grading/Excavation/Fill Inspection Partial 10/4/2019 10/04/2019
Misc
Informational
10/04/2019
10-4-19 They are digging out for the turn lane. They hit a communication line for traffic signals. The contractor will be making the repairs.
Grading/Excavation/Fill Inspection Partial 10/7/2019 10/07/2019
Misc
Informational
10/04/2019
10-4-19 They are digging out for the turn lane. They hit a communication line for traffic signals. The contractor will be making the repairs.
Misc
Informational
10/07/2019
10-7-19 They have the geogrid and base installed. They are getting ready to cut grade. They will be hand pouring and doing a monolithic curb.
Grading/Excavation/Fill Inspection Partial 10/07/2019
Misc
Informational
10/07/2019
10-4-19 They are digging out for the turn lane. They hit a communication line for traffic signals. The contractor will be making the repairs.
Misc
Informational
10/07/2019
10-7-19 They have the geogrid and base installed. They are getting ready to cut grade. They will be hand pouring and doing a monolithic curb.
Misc
Informational
10/07/2019
10-7-19 They are ready to pour the turn lane on Chipman. They will be pouring tomorrow at 9am.
Street - Surface Course Partial 10/8/2019 10/08/2019
Misc
Informational
10/08/2019

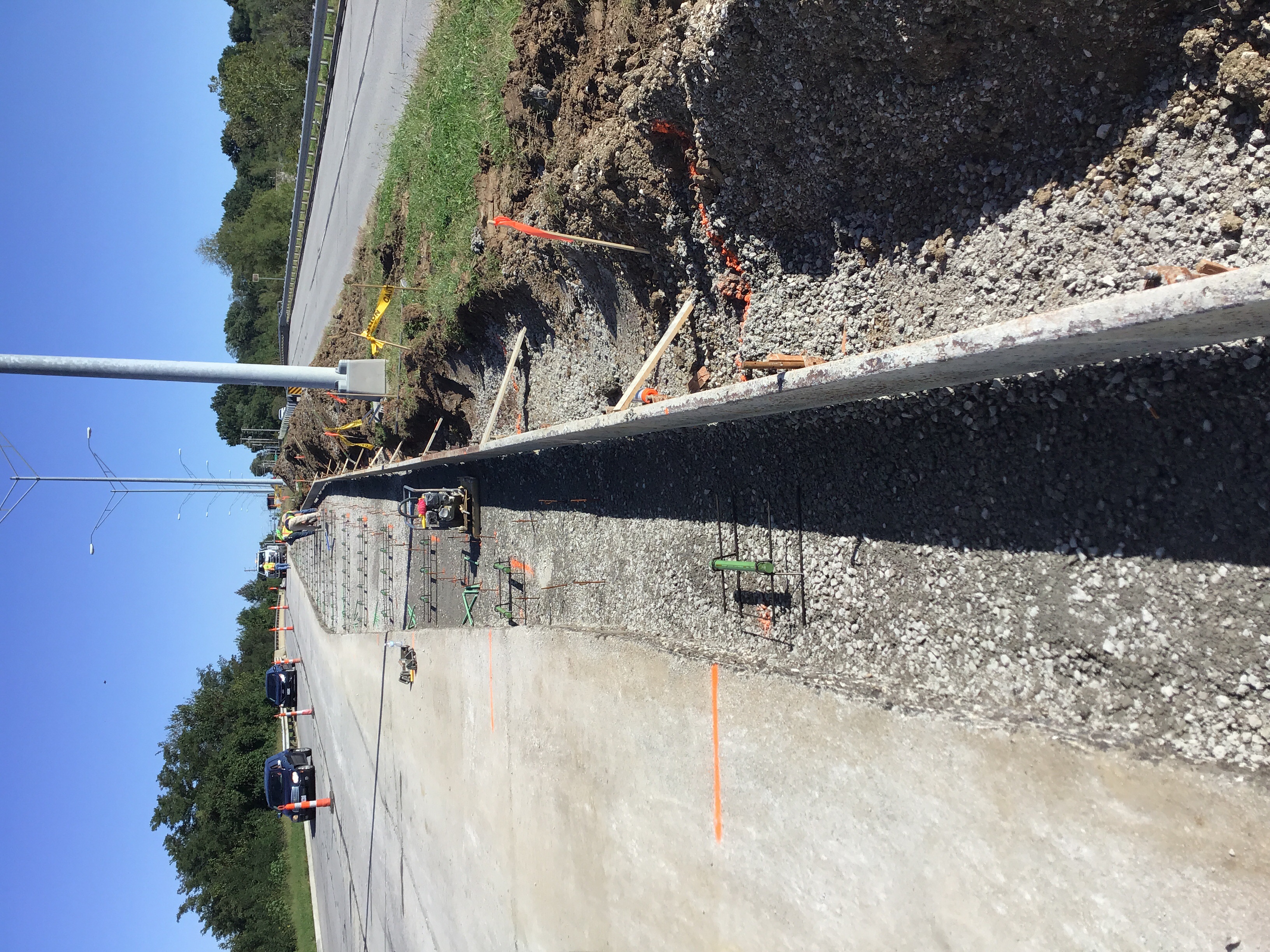

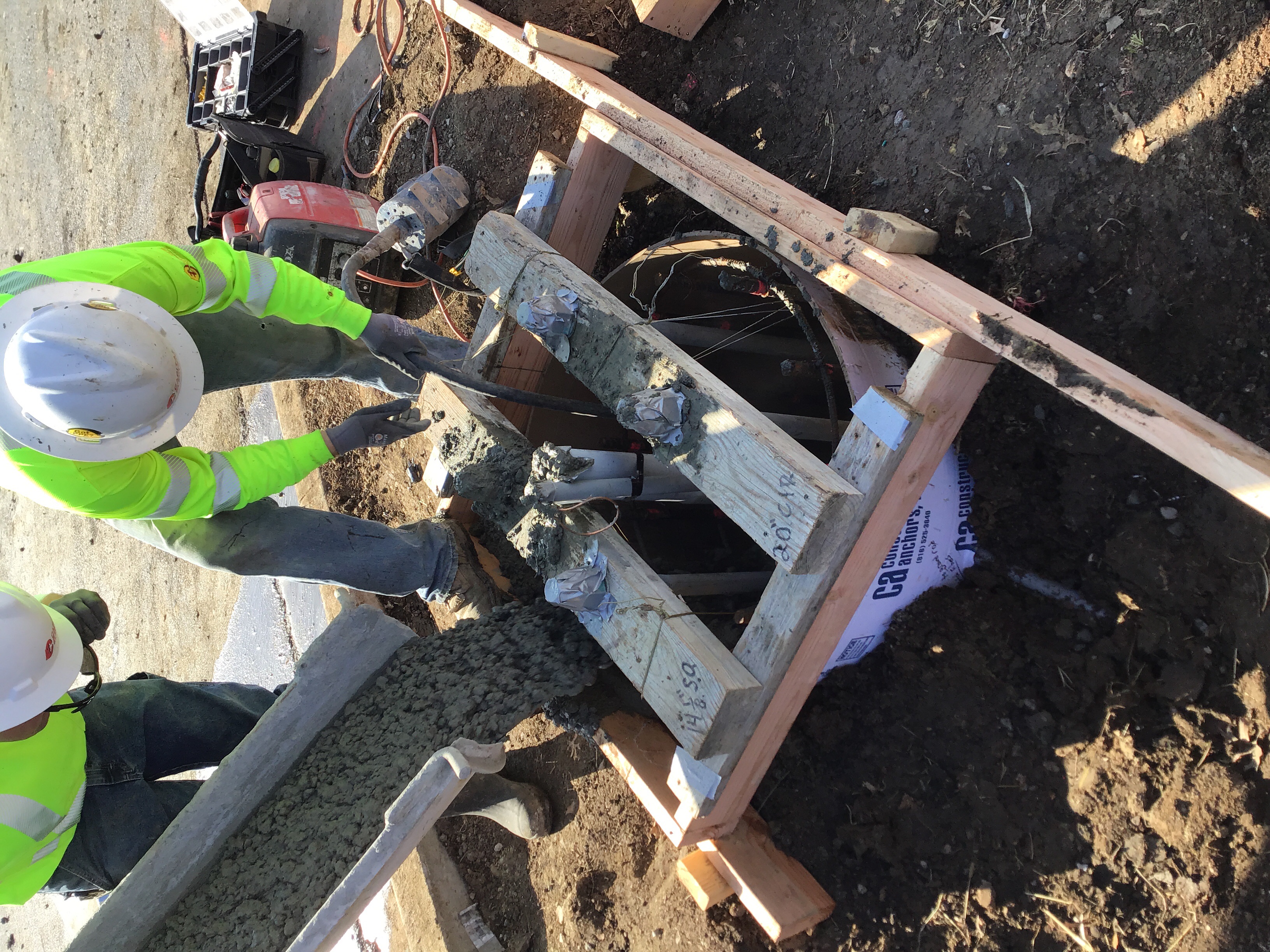

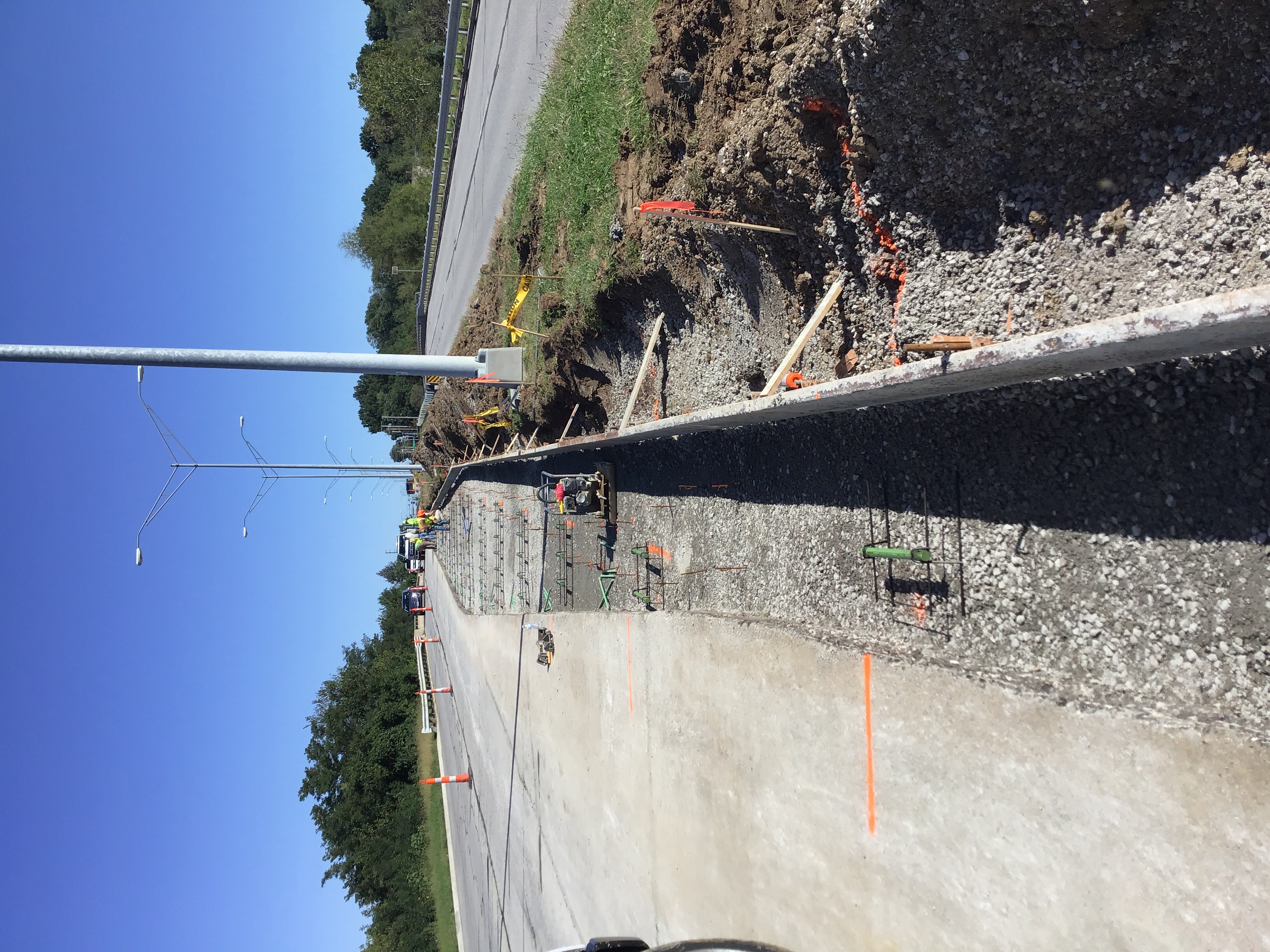

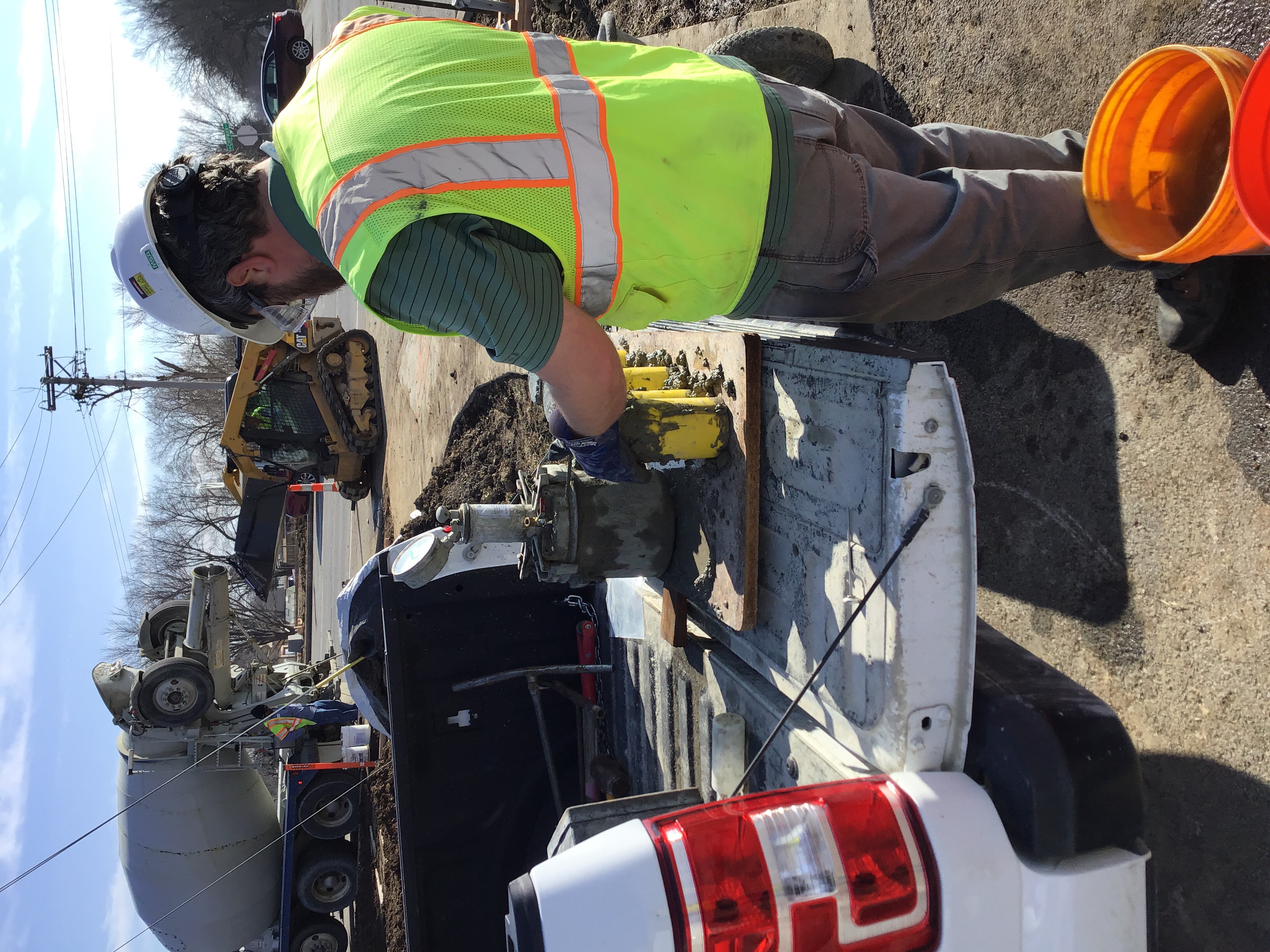

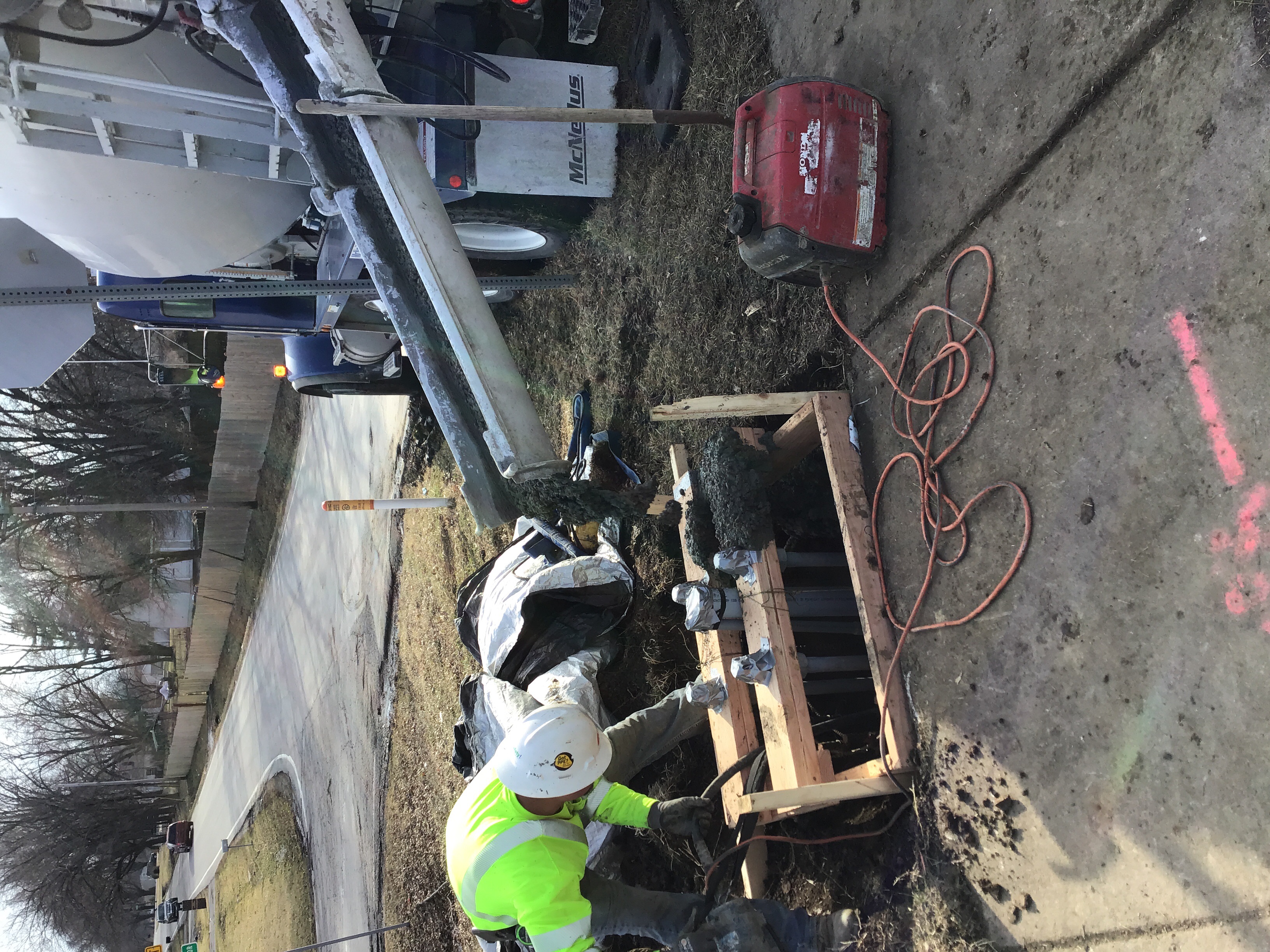

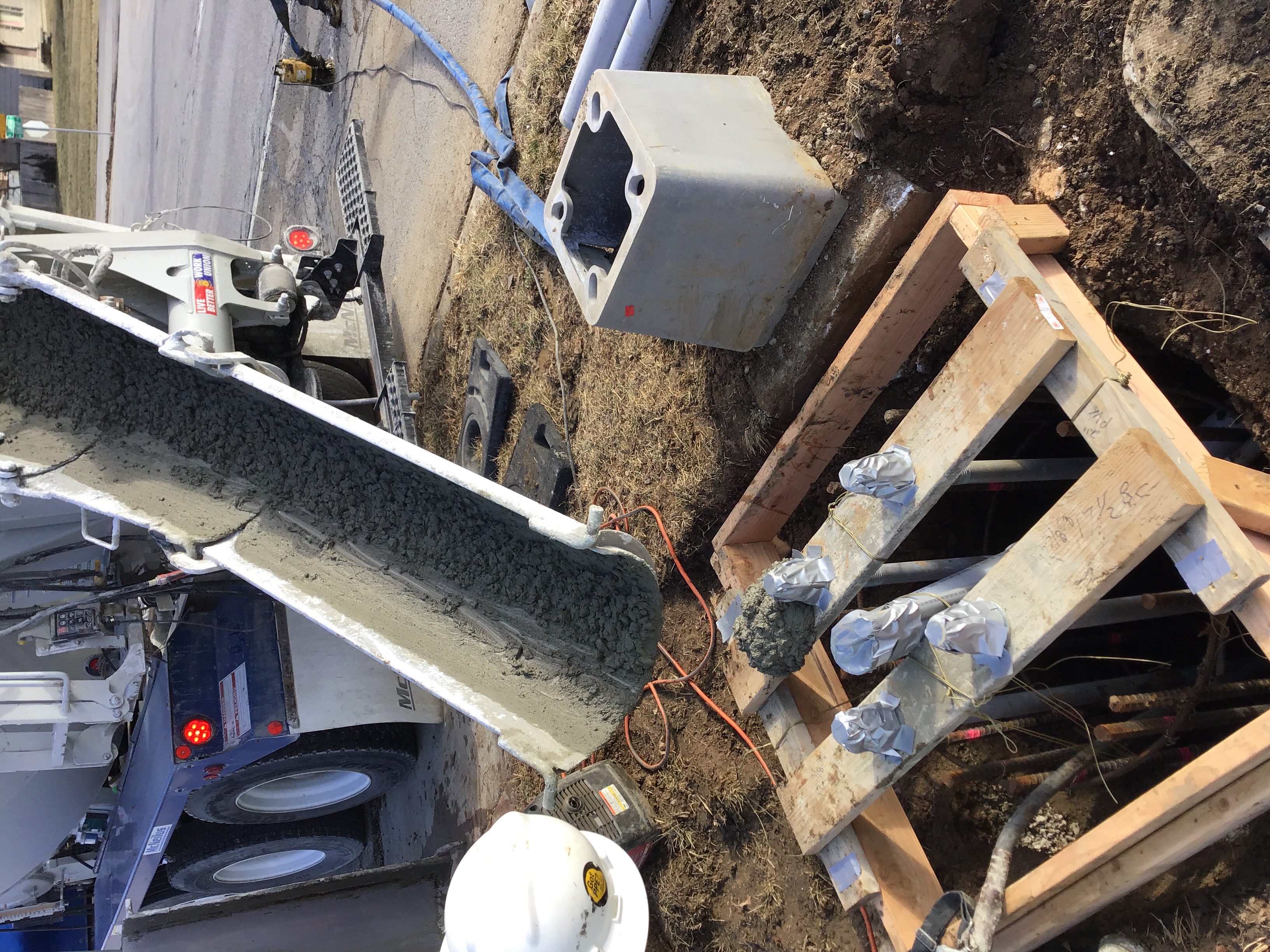

10-8-19 They started pouring concrete for the turn lane on Chipman at approximately 9:15am using the 4K mix.
Misc
Informational
10/08/2019
10-8-19 They started pouring concrete for the turn lane on Chipman at approximately 9:15am using the 4K mix. 3:37pm The turn lane is poured. They are pulling the forms so I having them cure the back side of the curb.
Site Visit Partial 1/27/2020 01/27/2020
Misc
Informational
01/27/2020
1-27-20 There was no one on site today.
Underground Electrical Inspection - Commercial Partial 2/6/2020 02/06/2020
Misc
Informational
02/06/2020

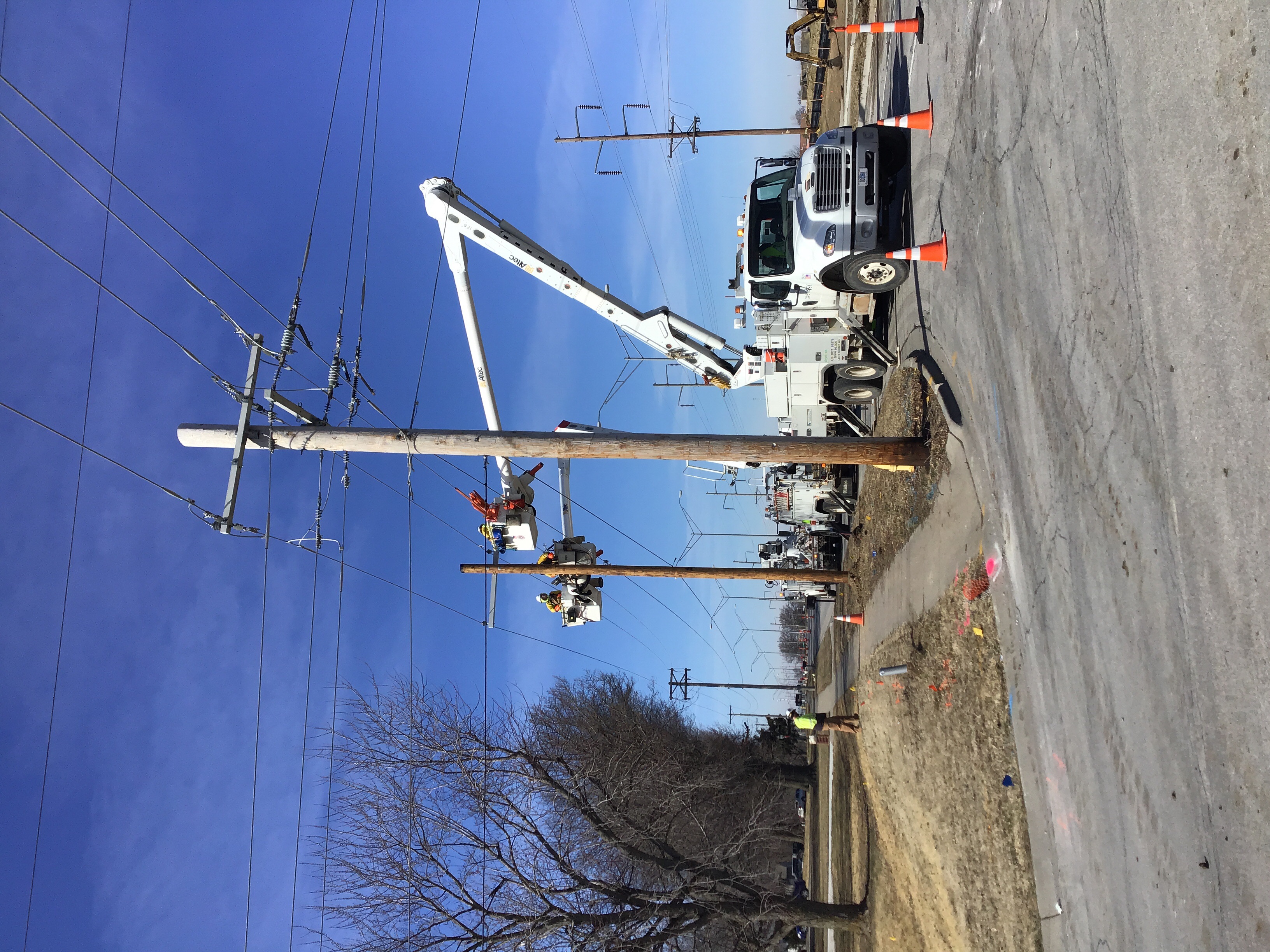

2-6-20 They have set pull boxes 2,8,and 10 and are digging at the north west corner. They have forms set on the north west corner and are having issues with pole placement on the north east corner. There appears to be utility’s in the way as well as a storm pipe were the pole was marked to go. ESS will be reaching out to Evergy for overhead clearance.
Miscellaneous PWORKS Inspection Partial 2/7/2020 02/07/2020
Misc
Informational
02/07/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Miscellaneous PWORKS Inspection Partial 2/10/2020 02/10/2020
Misc
Informational
02/07/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/10/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Miscellaneous PWORKS Inspection Partial 2/11/2020 02/14/2020
Misc
Informational
02/10/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/10/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Miscellaneous PWORKS Inspection Partial 2/14/2020 02/14/2020
Misc
Informational
02/14/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/14/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
02/14/2020

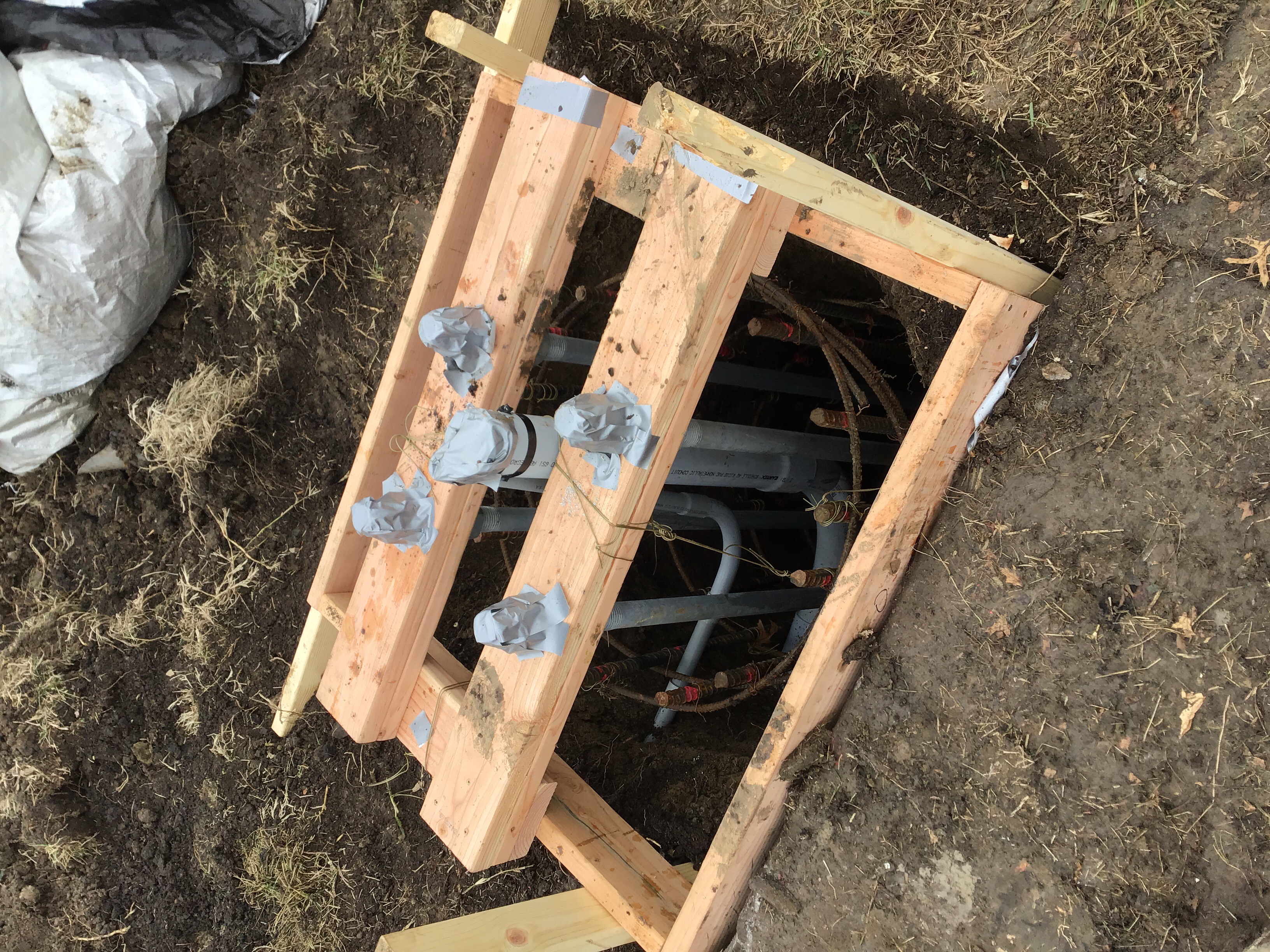

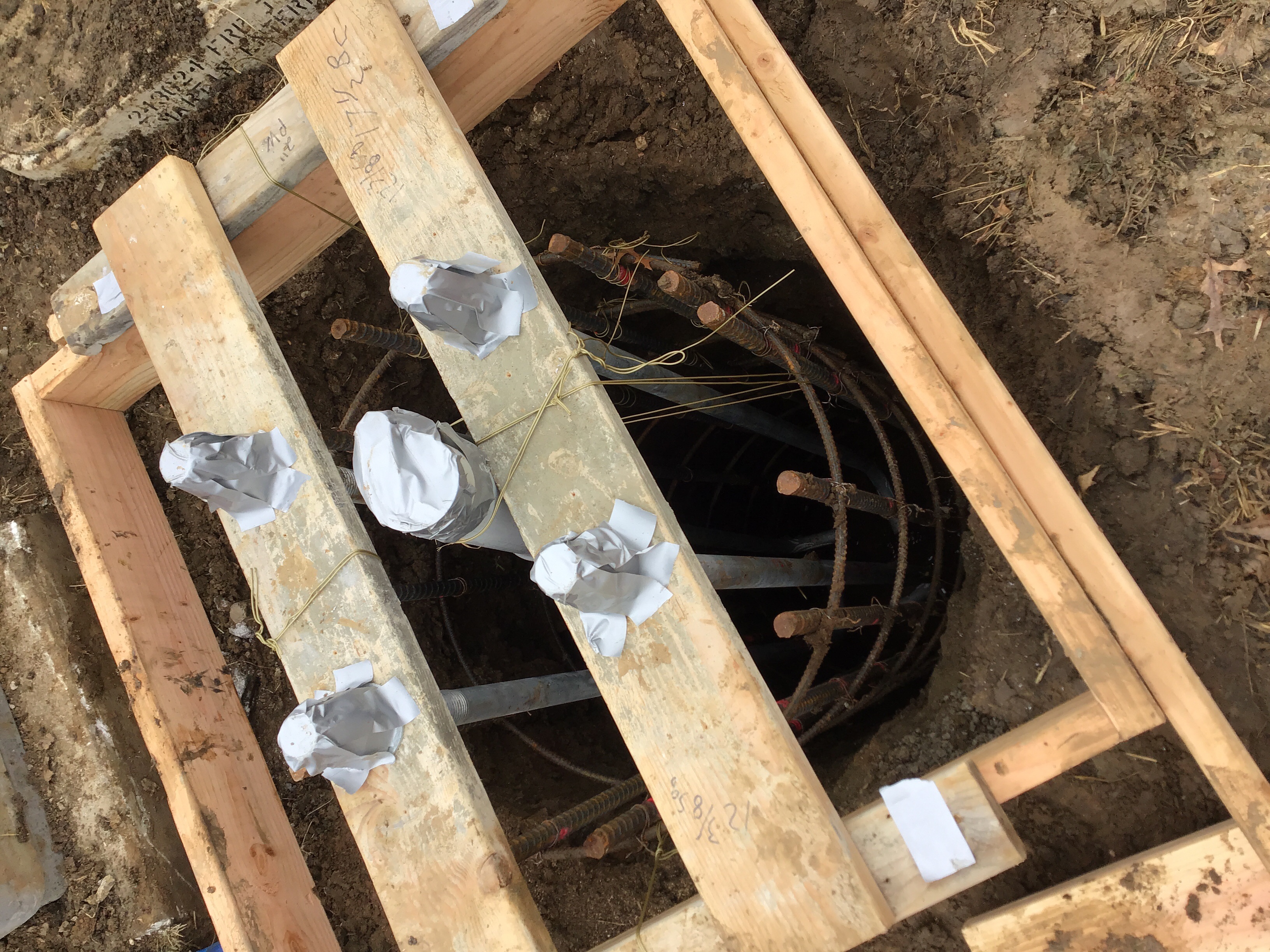

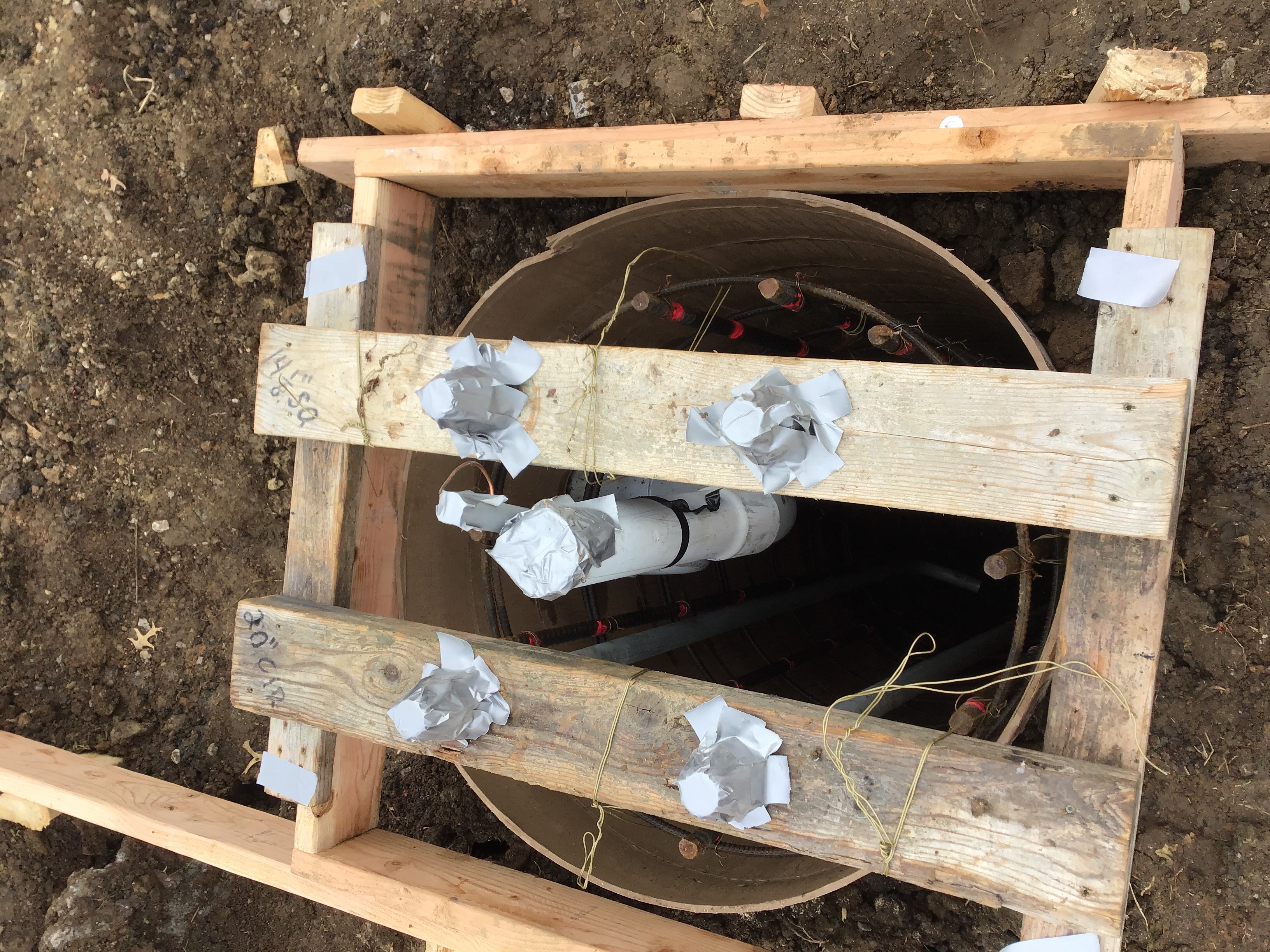

2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Miscellaneous PWORKS Inspection Partial 2/17/2020 02/17/2020
Misc
Informational
02/14/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/14/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
02/14/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
02/17/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured.
Miscellaneous PWORKS Inspection Partial 2/18/2020 02/18/2020
Misc
Informational
02/17/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/17/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
02/17/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
02/17/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps.
Miscellaneous PWORKS Inspection Partial 2/18/2020 02/18/2020
Misc
Informational
02/18/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/18/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
02/18/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
02/18/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Electrical Service Inspection Passed 2/28/2020 at 2:40 PM 02/28/2020
Miscellaneous PWORKS Inspection Partial 3/2/2020 03/02/2020
Misc
Informational
02/18/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
02/18/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
02/18/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
02/18/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/02/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Miscellaneous PWORKS Inspection Partial 3/2/2020 03/02/2020
Misc
Informational
03/02/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/02/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/02/2020

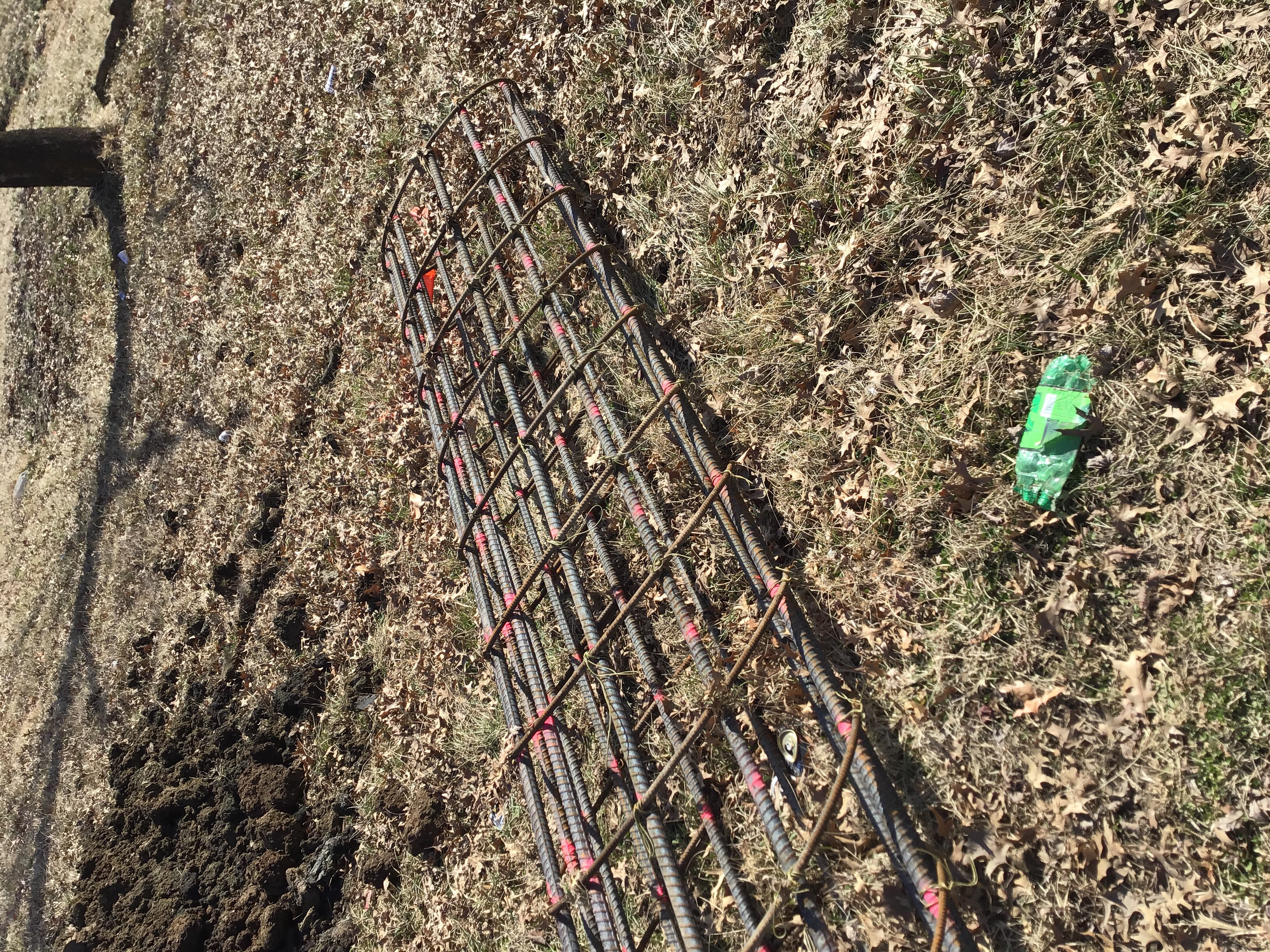

2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/02/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/02/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/02/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Sidewalk Inspection Partial 03/06/2020
Misc
Informational
03/06/2020
3-6-20 They have poured the curb on the south west corner of Donavon and are now pouring the sidewalk with ADA ramps.
Miscellaneous PWORKS Inspection Partial 3/12/2020 03/12/2020
Misc
Informational
03/02/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/02/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/02/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/02/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/02/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/02/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Miscellaneous PWORKS Inspection Partial 3/13/2020 03/17/2020
Misc
Informational
03/12/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/12/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/12/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/12/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/12/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/12/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/12/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads.
Miscellaneous PWORKS Inspection Partial 3/17/2020 03/17/2020
Misc
Informational
03/17/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/17/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/17/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/17/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/17/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/17/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Sidewalk Inspection Passed 3/18/2020 03/18/2020
Misc
Informational
03/06/2020
3-6-20 They have poured the curb on the south west corner of Donavon and are now pouring the sidewalk with ADA ramps.
Misc
Informational
03/18/2020
3-18-20 The sidewalk is ADA compliant.
Miscellaneous PWORKS Inspection Partial 3/23/2020 03/23/2020
Misc
Informational
03/17/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/17/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/17/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/17/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/17/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/17/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/17/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Misc
Informational
03/23/2020
3-23-20 9:16am Capital is on site running and hooking up fiber lines. 3:34pm They have formed up to pour aprons. We will be meeting on site 3-25-20 at 9am for a over view inspection of all the lights and wiring.
Miscellaneous PWORKS Inspection Partial 3/25/2020 03/25/2020
Misc
Informational
03/23/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/23/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/23/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/23/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/23/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/23/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/23/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/23/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/23/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/23/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Misc
Informational
03/23/2020
3-23-20 9:16am Capital is on site running and hooking up fiber lines. 3:34pm They have formed up to pour aprons. We will be meeting on site 3-25-20 at 9am for a over view inspection of all the lights and wiring.
Misc
Informational
03/25/2020
3-25-20 10:09am I’ve spoke with Dennis with public works who is on site. The signs in the islands on Chipman that indicate “stay right” will need to be removed and Capital is still working on getting the signal lights worked out. They are having issues with wiring right now. Public works cycled the lights.
Miscellaneous PWORKS Inspection Partial 04/02/2020
Misc
Informational
03/25/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
03/25/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
03/25/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
03/25/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
03/25/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
03/25/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
03/25/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/25/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/25/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
03/25/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Misc
Informational
03/25/2020
3-23-20 9:16am Capital is on site running and hooking up fiber lines. 3:34pm They have formed up to pour aprons. We will be meeting on site 3-25-20 at 9am for a over view inspection of all the lights and wiring.
Misc
Informational
03/25/2020
3-25-20 10:09am I’ve spoke with Dennis with public works who is on site. The signs in the islands on Chipman that indicate “stay right” will need to be removed and Capital is still working on getting the signal lights worked out. They are having issues with wiring right now. Public works cycled the lights.
Misc
Informational
03/26/2020
3-26-20 8:26am K&G Striping are on site laying out the crosswalk’s. Capital is on site wrecking forms.
Misc
Informational
04/02/2020
4-1-20 Capital poured the two remaining aprons.
Miscellaneous PWORKS Inspection Partial 4/7/2020 04/07/2020
Misc
Informational
04/02/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
04/02/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
04/02/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
04/02/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
04/02/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
04/02/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
04/02/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/02/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/02/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/02/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Misc
Informational
04/02/2020
3-23-20 9:16am Capital is on site running and hooking up fiber lines. 3:34pm They have formed up to pour aprons. We will be meeting on site 3-25-20 at 9am for a over view inspection of all the lights and wiring.
Misc
Informational
04/02/2020
3-25-20 10:09am I’ve spoke with Dennis with public works who is on site. The signs in the islands on Chipman that indicate “stay right” will need to be removed and Capital is still working on getting the signal lights worked out. They are having issues with wiring right now. Public works cycled the lights.
Misc
Informational
04/02/2020
3-26-20 8:26am K&G Striping are on site laying out the crosswalk’s. Capital is on site wrecking forms.
Misc
Informational
04/02/2020
4-1-20 Capital poured the two remaining aprons.
Misc
Informational
04/07/2020
4-7-20 8:57am They have pull box 2 and 3 poured and are setting up pull box 4 at this time.
Miscellaneous PWORKS Inspection Passed 04/24/2020
Misc
Informational
04/07/2020
2-7-20 9:40am I spoke with Mike Confer about the pole location. I informed him that we were waiting on awsers from Evergy. 1:18pm Mike with capital is needing to move a pedistol pole due to AT&T line being in the way. I told him we would check on it and let him know. After speaking with Erin Capital is allowed to move the pedistol pole to the south side of the sidewalk.
Misc
Informational
04/07/2020
2-10-20 8:20am There is no work taking place at this time. 11:30am Capital is on site and have placed a new power pole at the south west corner. They have board out holes for signal pole’s No. 2 and 10 at this time. They will be boaring for No. 8 after lunch. 1:30pm They have the hole board out for number 8 and have pulled to the north side. Capital has the transformer hug on the new pole.
Misc
Corrective Action Required
04/07/2020
2-14-20 9:35am Capital is on site setting the steel and forming to pour light pole bases. They are planning on pouring Monday 2-17-20 at 10am.
Misc
Informational
04/07/2020
3-23-20 9:16am Capital is on site running and hooking up fiber lines. 3:34pm They have formed up to pour aprons. We will be meeting on site 3-25-20 at 9am for a over view inspection of all the lights and wiring.
Misc
Informational
04/07/2020
3-25-20 10:09am I’ve spoke with Dennis with public works who is on site. The signs in the islands on Chipman that indicate “stay right” will need to be removed and Capital is still working on getting the signal lights worked out. They are having issues with wiring right now. Public works cycled the lights.
Misc
Informational
04/07/2020
3-26-20 8:26am K&G Striping are on site laying out the crosswalk’s. Capital is on site wrecking forms.
Misc
Informational
04/07/2020
2-17-20 10:45am Capital is on site cleaning out the holes for the signal poles and will be pouring at 2pm. All holes are at correct depth and have steel installed. 2:02pm Terracon is on site for testing. They are pouring at the NW corner first. Terracon ran test on the first truck. He was good with the tests and they can pour. 2:55pm They have poured the north side and are pouring in the island on the east side. 3:10pm The are pouring the pole base in the West Island. 3:25pm They are pouring the last pole base on the SE corner. 3:34pm 10,8,9, and 2 pole bases are poured. 2-18-20 10:22am Fordyce Concrete was on site at 10am and I have collected the concrete ticket.They are pouring out the rest of the bases with 4K mix. They have been told to cover everything poured with blankets due to temps. 2:55pm They have everything covered with blankets.
Misc
Informational
04/07/2020
Joe Starlin 03/02/2020 7:29 AM On Friday 2-28-20 Capital met there breaks for strength on the concrete and removed all blankets. Monday 3-2-20 They are planning on wrecking all forms.
Misc
Informational
04/07/2020
3-2-20 Brian Bird and I walked the site. The forms have not been wrecked. There is no one working at this site at this time.
Misc
Informational
04/07/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/07/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/07/2020
4-1-20 Capital poured the two remaining aprons.
Misc
Informational
04/07/2020
3-12-20 Capital are on site setting light Poles. They have 7C-14 Signal Heads, 5C-14 Pedestrian Heads, 2C-14 Push buttons, CAT5 Camera, and M138 Opticom that is being ran.
Misc
Informational
04/07/2020
Joe Starlin 03/17/2020 7:08 AM On 3-13-20 they installed two 15' pedestals poles and three section heads. 2:37pm 3-17-20 They have hung two signal arms over Chipman and installed two 5 head signals along with signs.
Misc
Informational
04/07/2020
4-7-20 8:57am They have pull box 2 and 3 poured and are setting up pull box 4 at this time. 4-24-20 All of the stop signal work is complete and operating.
Curb - Proof Roll Passed 05/28/2020
Pavement-Proof Roll Passed 05/28/2020
Pavement-Surface Passed 05/28/2020
Final Electrical Inspection - Commercial Not Ready 05/28/2020
Erosion Control Inspection Passed 05/28/2020
Grading/Excavation/Fill Inspection Passed 05/28/2020
Misc
Informational
10/07/2019
10-4-19 They are digging out for the turn lane. They hit a communication line for traffic signals. The contractor will be making the repairs.
Misc
Informational
10/07/2019
10-7-19 They have the geogrid and base installed. They are getting ready to cut grade. They will be hand pouring and doing a monolithic curb.
Misc
Informational
10/07/2019
10-7-19 They are ready to pour the turn lane on Chipman. They will be pouring tomorrow at 9am.
Street - Surface Course Passed 05/28/2020
Misc
Informational
10/08/2019
10-8-19 They started pouring concrete for the turn lane on Chipman at approximately 9:15am using the 4K mix.
Misc
Informational
10/08/2019
10-8-19 They started pouring concrete for the turn lane on Chipman at approximately 9:15am using the 4K mix. 3:37pm The turn lane is poured. They are pulling the forms so I having them cure the back side of the curb.
Final Electrical Inspection - Commercial Passed 05/28/2020
Documents & Images
Date Uploaded File Type Document Name
09/25/2019 Receipt Receipt for transaction: 2019-006434
09/25/2019 Receipt Receipt for transaction: 2019-006434
09/26/2019 Letter DE-Permit
10/04/2019 Summit Orchard Signalization petmit
10/04/2019 Letter DE-Daily Inspection Summary
10/07/2019 image
10/07/2019 image0
02/10/2020 Cage for south east pole
02/10/2020 new pole south west corner power
02/17/2020 Island west side
02/17/2020 13’ for signal N E corner
02/17/2020 SE corner pole pad

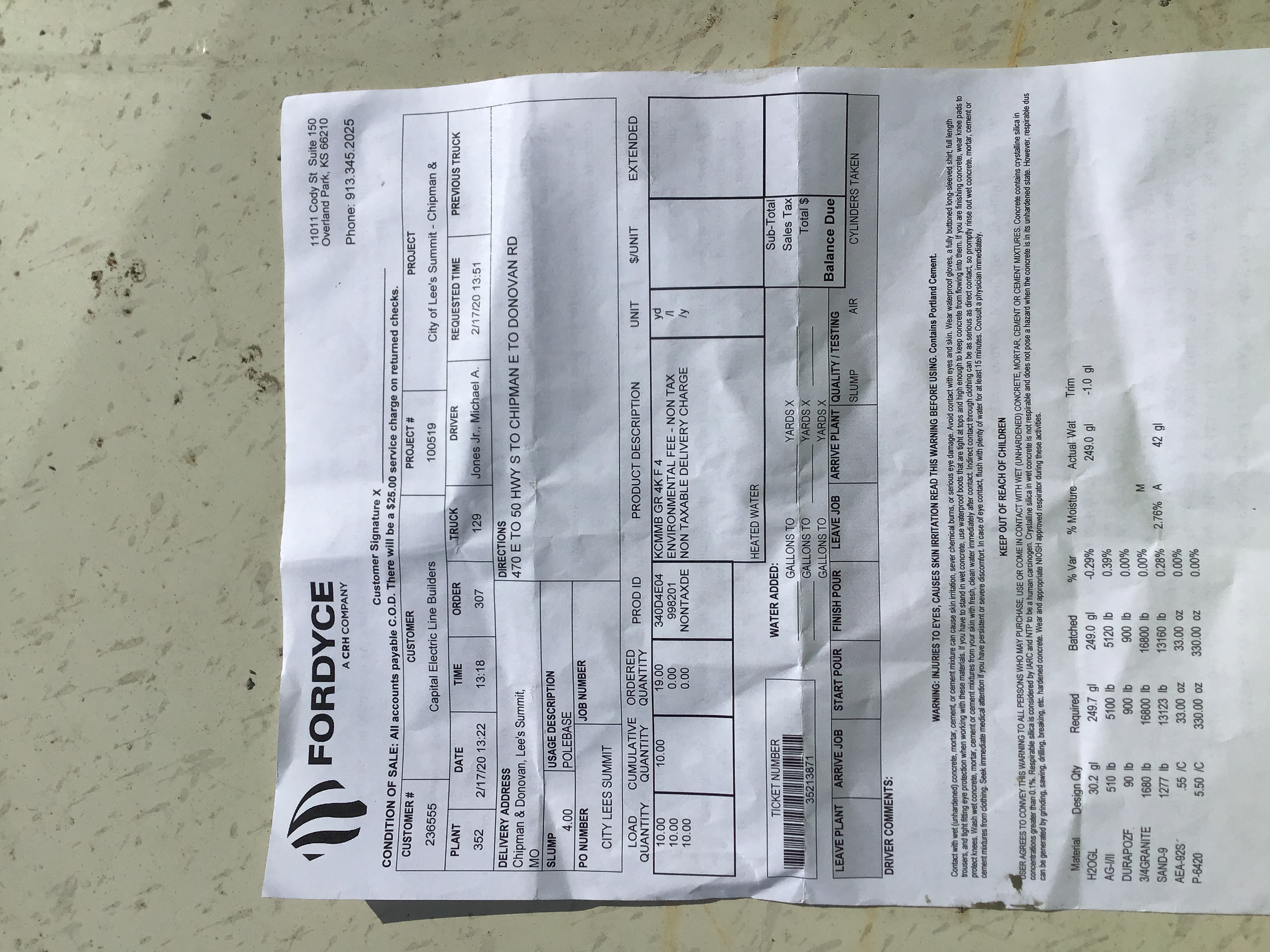

02/17/2020 Concrete ticket for signals
02/17/2020 Terracon testi
02/17/2020 Vibrating pole base
02/17/2020 East island
02/17/2020 West pole base
02/17/2020 SE corner pole base
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/28/2020 Letter INSPECTION SUMMARY
03/02/2020 Letter INSPECTION SUMMARY
03/02/2020 Letter INSPECTION SUMMARY
03/06/2020 Letter INSPECTION SUMMARY
03/12/2020 Letter INSPECTION SUMMARY
03/17/2020 Letter INSPECTION SUMMARY
03/17/2020 Letter INSPECTION SUMMARY
03/18/2020 Letter INSPECTION SUMMARY
03/18/2020 Letter INSPECTION SUMMARY
03/23/2020 Letter INSPECTION SUMMARY
03/25/2020 Letter INSPECTION SUMMARY
04/02/2020 Letter INSPECTION SUMMARY
04/07/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter DE-Punch List
05/28/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
05/28/2020 Summit Orchard Street and Signal Maintenance Bond
05/28/2020 Letter DE-Certificate of Final Acceptance (Commercial)
05/28/2020 Summmit Orchard Street and Signal Final Acceptance
05/28/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
05/28/2020 Affidavit of Compliance For City of LS
05/01/2020 Plans Donovan & Chipman Signal Improvement Redlined Plans
05/01/2020 Plans Chipman and Donovan Fiber INFO
04/23/2021 Receipt Receipt for transaction: 2021-002196
04/23/2021 scan_mweisen_2021-04-23-15-21-01
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
