Permit Application Status

PRSUBD20182996

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSUBD20182996
Public Infrastructure
Final Acceptance
OAK VIEW LEES SUMMIT LLC
DEVELOPMENT COMPLETE
Private infrustructure for multiple lot development.
09/06/2018
11/16/2018
12/18/2020
Locations
Contacts
OAK VIEW LEES SUMMIT LLC, Address:201 HAWKS RIDGE TRL
SCHLAGEL & ASSOCIATES, Address:14920 W 107TH ST, Phone:(913) 492-5158
PROSSER WILBERT CONSTRUCTION INC, Address:13730 W 108TH ST, Phone:(913) 906-0104
Alan Gentry, Address:Prosser/Wilbert Construction, Phone:(913) 208-3865
Reviews
Review Type Outcome Est. Completion Date Completed
Master Draingage As-built Review Approved 11/10/2020 12/18/2020
Steve Robbins
Licensed Contractors Approved 09/06/2018 09/07/2018
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $2,034.30 $2,034.30 Paid 09/13/2018
9110068-Storm Fee $9,931.50 $9,931.50 Paid 11/28/2018
9110081-Paved Surface Inspection Fee $4,242.29 $4,242.29 Paid 11/28/2018
91100C9-Water Insp Fee $3,225.60 $3,225.60 Paid 11/28/2018
9110071-Site Grading Fee $5,898.60 $5,898.60 Paid 11/28/2018
9110072-Water Test Fee $200.00 $200.00 Paid 11/28/2018
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $75.00 $0.00 $75.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $300.00 $0.00 $300.00 Not Paid

$375.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 11/15/2018 at 9:00 AM 11/16/2018
Misc
Informational
11/16/2018
Prior to 11/15/18 they bored under Victoria RD and installed sanitary sewer. 11/15/18 They placed sanitary pipe and back filled 90.51 LF from A1 to A2.
Sanitary Sewer Construction Inspection Partial 11/16/2018 at 10:45 AM 11/16/2018
Misc
Informational
11/16/2018
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Sanitary Sewer Construction Inspection Partial 11/19/2018
Misc
Informational
11/19/2018
The crew set and installed MH A-3. I verified that the location matches the approved plans. I will return for further inspection.
Sanitary Sewer Construction Inspection Partial 11/19/2018
Misc
Informational
11/19/2018
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
11/19/2018
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Sanitary Sewer Construction Inspection Partial 11/20/2018
Misc
Informational
11/19/2018
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
11/19/2018
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
11/20/2018
Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Site Visit Partial 12/4/2018 at 8:00 AM 12/04/2018
Misc
Informational
12/04/2018
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Sanitary Sewer Construction Inspection Partial 12/11/2018
Misc
Informational
11/20/2018
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
11/20/2018
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
11/20/2018
Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Misc
Corrective Action Required
12/11/2018
10:30 am Sanitary line has been placed from A-3 to approximately 100 feet past A-4 with service lines to the east and west installed. Alpha Omega Geotech is on site and doing compaction tests during backfill. 2:40 pm sanitary line has been placed to A-5 with a service line on the east side. One more service line needs to be installed.
Sanitary Sewer Construction Inspection Partial 12/12/2018
Misc
Informational
12/11/2018
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
12/11/2018
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
12/11/2018
Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Misc
Corrective Action Required
12/11/2018
10:30 am Sanitary line has been placed from A-3 to approximately 100 feet past A-4 with service Lines to the east and west installed. Alpha Omega Geotech is on site and doing compaction tests during backfill. 2:40 pm sanitary line has been placed to A-5 with a service line on the east side. One more service line needs to be installed.
Misc
Corrective Action Required
12/12/2018
10:40 AM Beemer Construction finished laying sanitary service line and poured two inverts and three trench checks.
Site Visit Partial 12/13/2018
Misc
Informational
12/04/2018
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
12/13/2018
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Site Visit Partial 12/17/2018 at 8:00 AM 12/18/2018
Misc
Informational
12/13/2018
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
12/13/2018
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
12/18/2018
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Site Visit Partial 12/18/2018
Misc
Informational
12/18/2018
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
12/18/2018
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
12/18/2018
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
12/18/2018
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Sanitary Sewer - Invert Partial 12/20/2018
Misc
Informational
12/20/2018
12/19/18 Manhole A-1 through A-5 inverts are good. Existing manhole invert will need some modification.
Site Visit Partial 1/2/2019 at 11:00 AM 01/02/2019
Misc
Informational
12/18/2018
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
12/18/2018
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
12/18/2018
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
12/18/2018
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/02/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Site Visit Partial 1/3/2019 at 10:00 AM 01/03/2019
Misc
Informational
01/02/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
01/02/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
01/02/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
01/02/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/02/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
01/03/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Site Visit Partial 01/07/2019
Misc
Informational
01/03/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
01/03/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
01/03/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
01/03/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/03/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
01/03/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
01/07/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Sanitary - Material Verification Passed 1/11/2019 01/11/2019
Misc
Informational
01/11/2019
All material on site for sanitary construction have been verified and meet the standard specifications.
Erosion Control Inspection Partial 1/11/2019 01/11/2019
Misc
Informational
01/11/2019
All erosion control measures are in place properly.
Detention Basin Partial 1/7/2019 at 8:00 AM 01/11/2019
Misc
Informational
01/11/2019

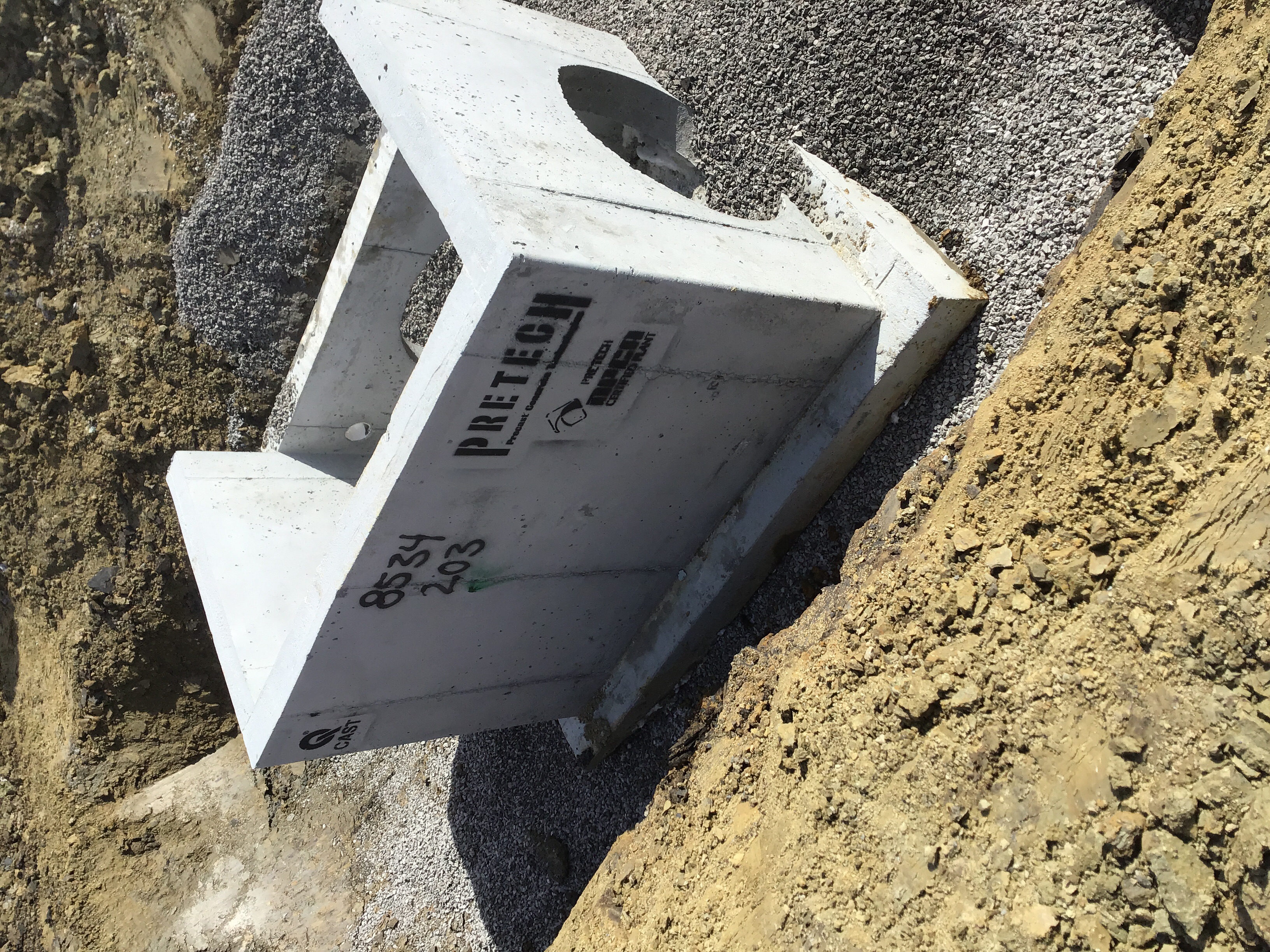

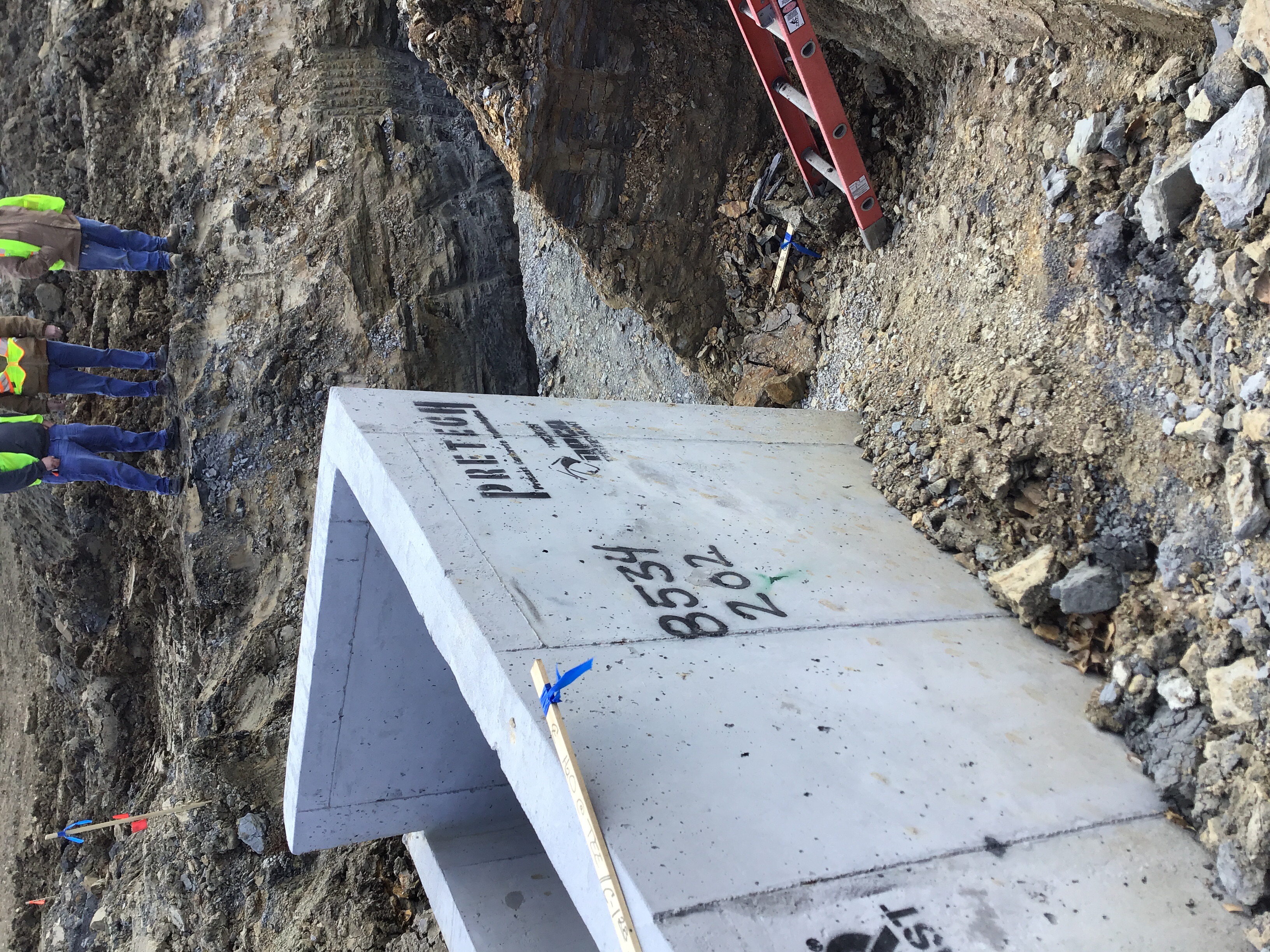

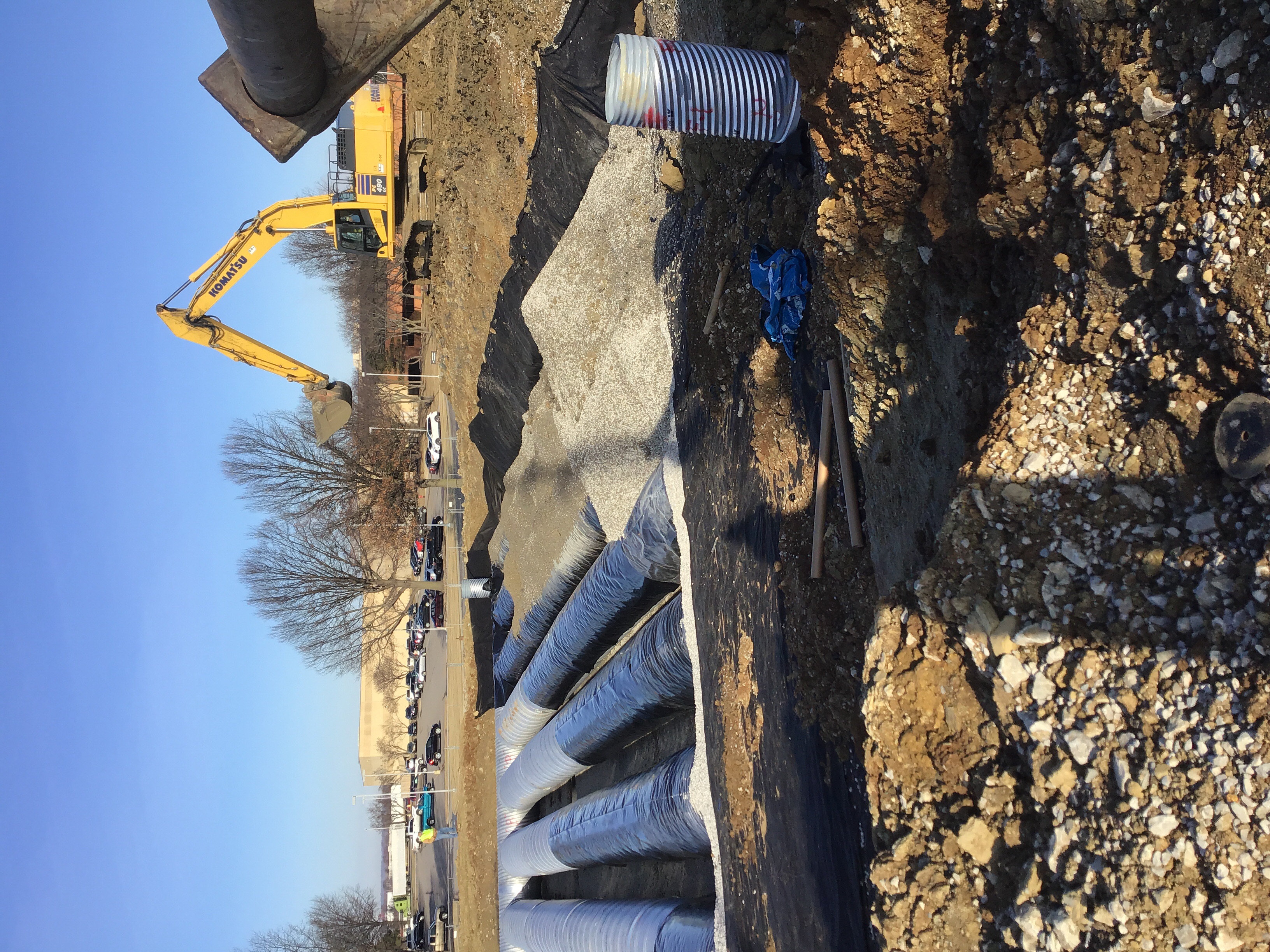

The 13,673 cu. ft. underground detention system has been installed and covered. The inspector for Contech Engineered Solutions John Willhoite was on site daily for the installation. He will be sending a report on the detention system.
Storm - Material Verification Partial 1/2/2019 01/11/2019
Informational
01/11/2019
All storm material on site appears to meet specifications.
Storm Sewer Construction Inspection Partial 1/7/2019 01/11/2019
Informational
01/11/2019

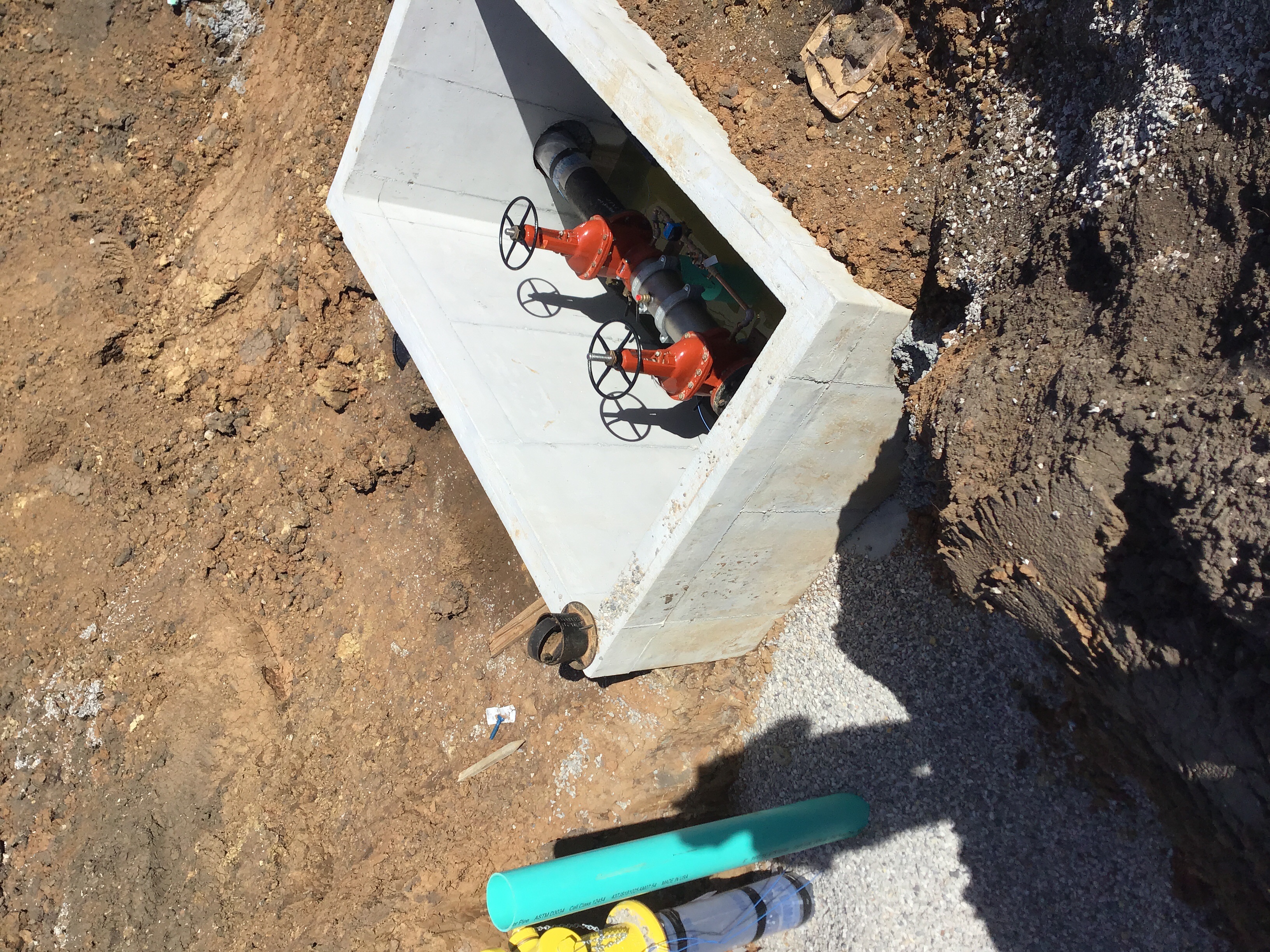

Storm inlet 601,602, and 501 have been installed along with storm pipe.
Sanitary Sewer - Mandrel Passed 1/15/2019 01/15/2019
Misc
Corrective Action Required
01/15/2019
The mandrel was pulled from A-5 through the entire sanitary line ending at the existing manhole on the south side of Victoria. The mandrel tag was verified for size.
Sanitary Sewer - Air Test Partial 1/15/2019 01/15/2019
Misc
Corrective Action Required
01/15/2019
1/15/19 Air test has been completed and passed from existing manhole on the south side of Victoria to manhole A-1. Air test from A-1 to A-2 is complete and passed. Air test from A-2 to A-3 is complete and passed. Air test A-3 to A-4 is complete and passed. We intend to test A-4 to A-5 on 1/16/19.
Sanitary Sewer - Air Test Passed 01/16/2019
Misc
Corrective Action Required
01/15/2019
1/15/19 Air test has been completed and passed from existing manhole on the south side of Victoria to manhole A-1. Air test from A-1 to A-2 is complete and passed. Air test from A-2 to A-3 is complete and passed. Air test A-3 to A-4 is complete and passed. We intend to test A-4 to A-5 on 1/16/19.
Misc
Corrective Action Required
01/16/2019
1/16/19 Manhole A-4 to A-5 has been air tested and passed. This completes the intire sanitary line.
Sanitary Sewer - Vacuum Partial 1/16/2019 01/16/2019
Misc
Corrective Action Required
01/16/2019
1/16/19 9:15am 32 degrees out side The vacuum gauge has been verified. The vacuum test on manhole A-5 is complete and passed. 9:45am The vacuum test on manhole A-4 failed. 11:00am The vacuum test on A-1 is complete and passed. Testing will resume at 12:30pm. Vacuum test at A-2 12:50pm is complete and passed. Vacuum test at A-3 has been completed and passed. 1:20pm the crew is working to repair manhole A-4. 2:10pm The crew could not fix manhole A-4. Talked with Jim from Beemer Construction. Jim said they would try again on Friday 1/18/19.
Sanitary Sewer - Vacuum Passed 01/18/2019
Misc
Corrective Action Required
01/16/2019
1/16/19 9:15am 32 degrees out side The vacuum gauge has been verified. The vacuum test on manhole A-5 is complete and passed. 9:45am The vacuum test on manhole A-4 failed. 11:00am The vacuum test on A-1 is complete and passed. Testing will resume at 12:30pm. Vacuum test at A-2 12:50pm is complete and passed. Vacuum test at A-3 has been completed and passed. 1:20pm the crew is working to repair manhole A-4. 2:10pm The crew could not fix manhole A-4. Talked with Jim from Beemer Construction. Jim said they would try again on Friday 1/18/19.
Misc
Corrective Action Required
01/18/2019
1/18/19 manhole A-4 has been vacuum tested and passed.
Site Visit Partial 01/22/2019
Misc
Informational
01/07/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
01/07/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
01/07/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
01/07/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/07/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
01/07/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
01/07/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
01/22/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Site Visit Partial 01/25/2019
Misc
Informational
01/22/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
01/22/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
01/22/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
01/22/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/22/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
01/22/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
01/22/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
01/22/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
01/25/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Site Visit Partial 02/12/2019
Misc
Informational
01/25/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
01/25/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
01/25/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
01/25/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
01/25/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
01/25/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
01/25/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
01/25/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
01/25/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
02/12/2019

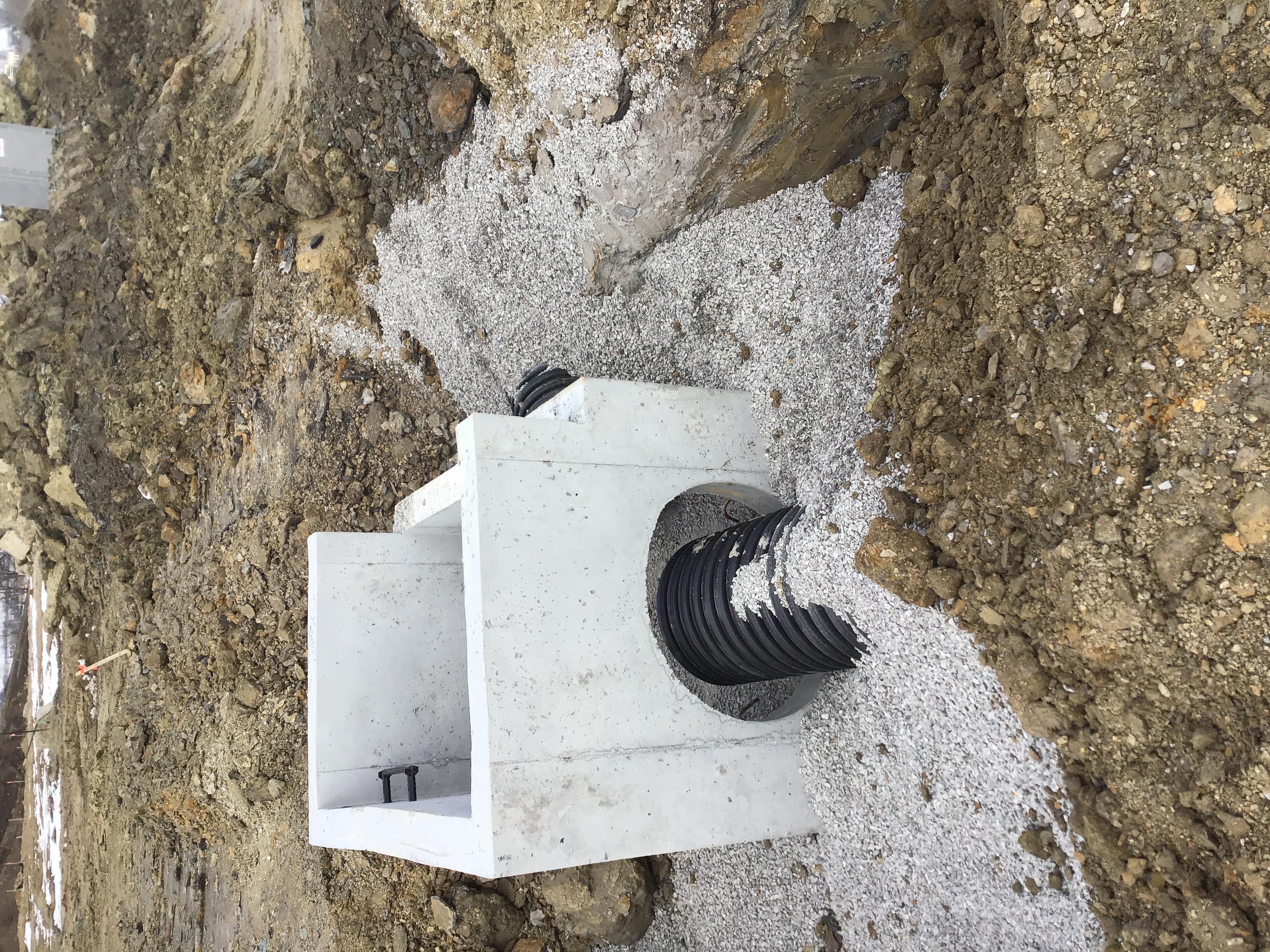

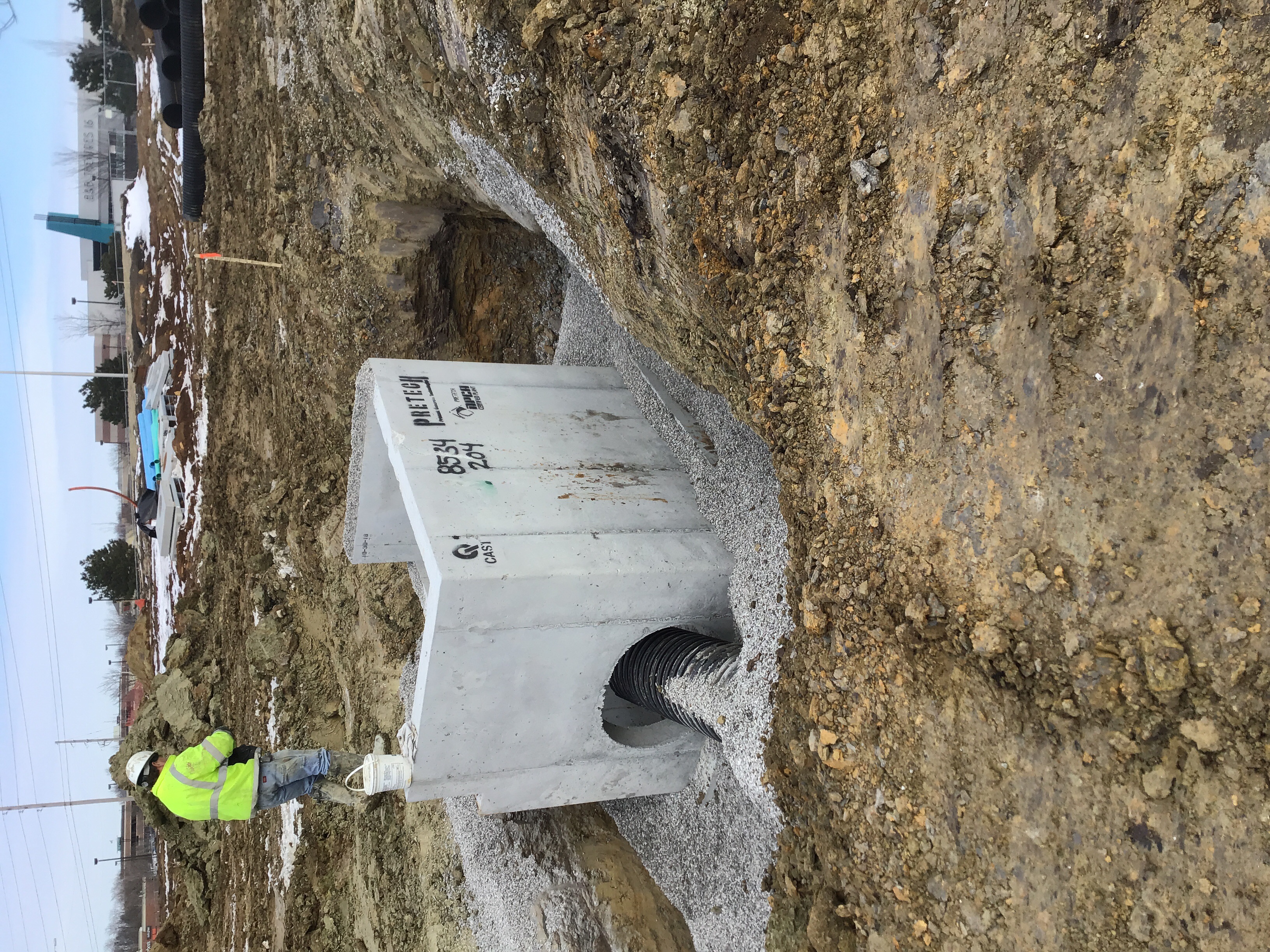

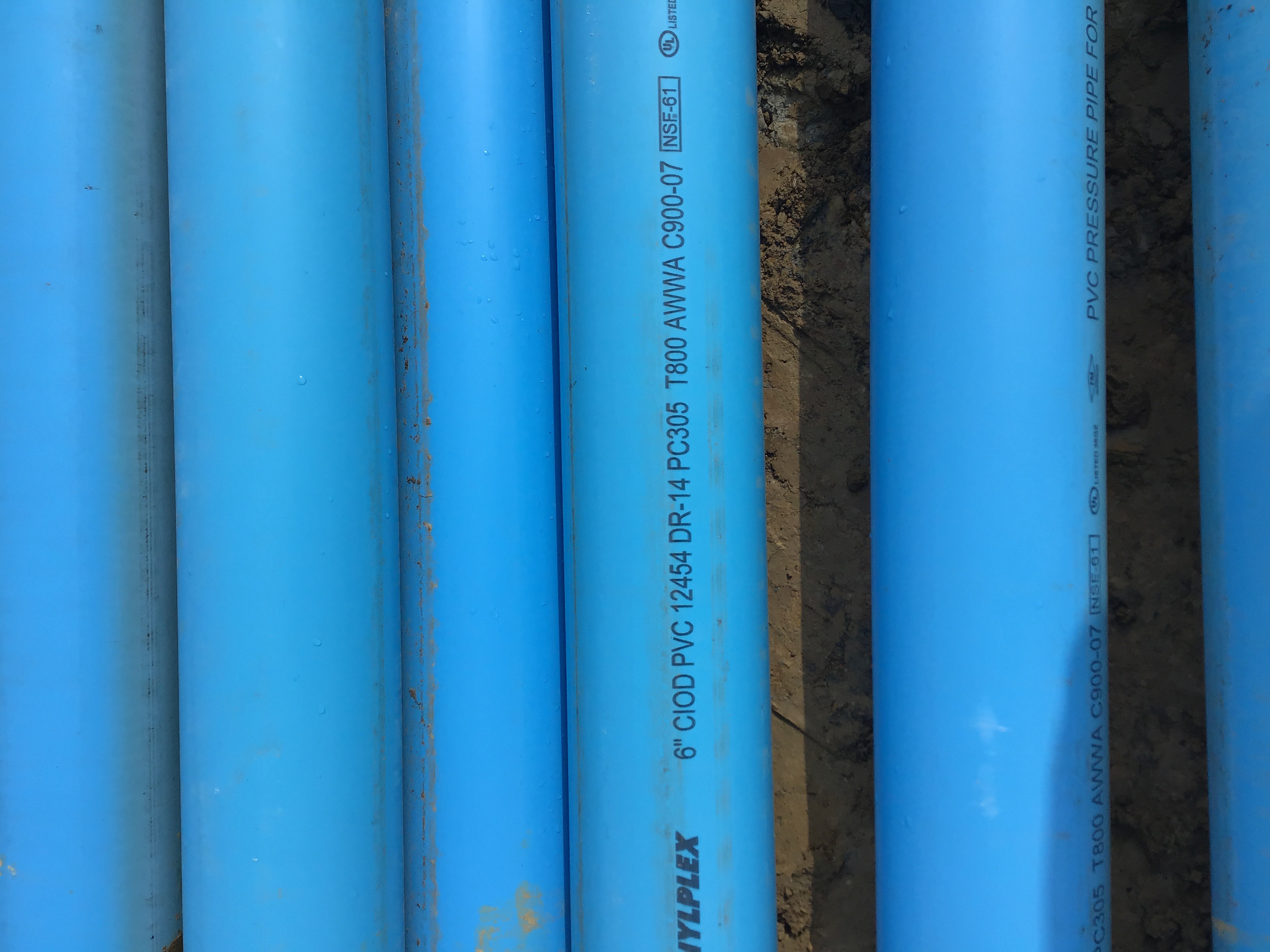

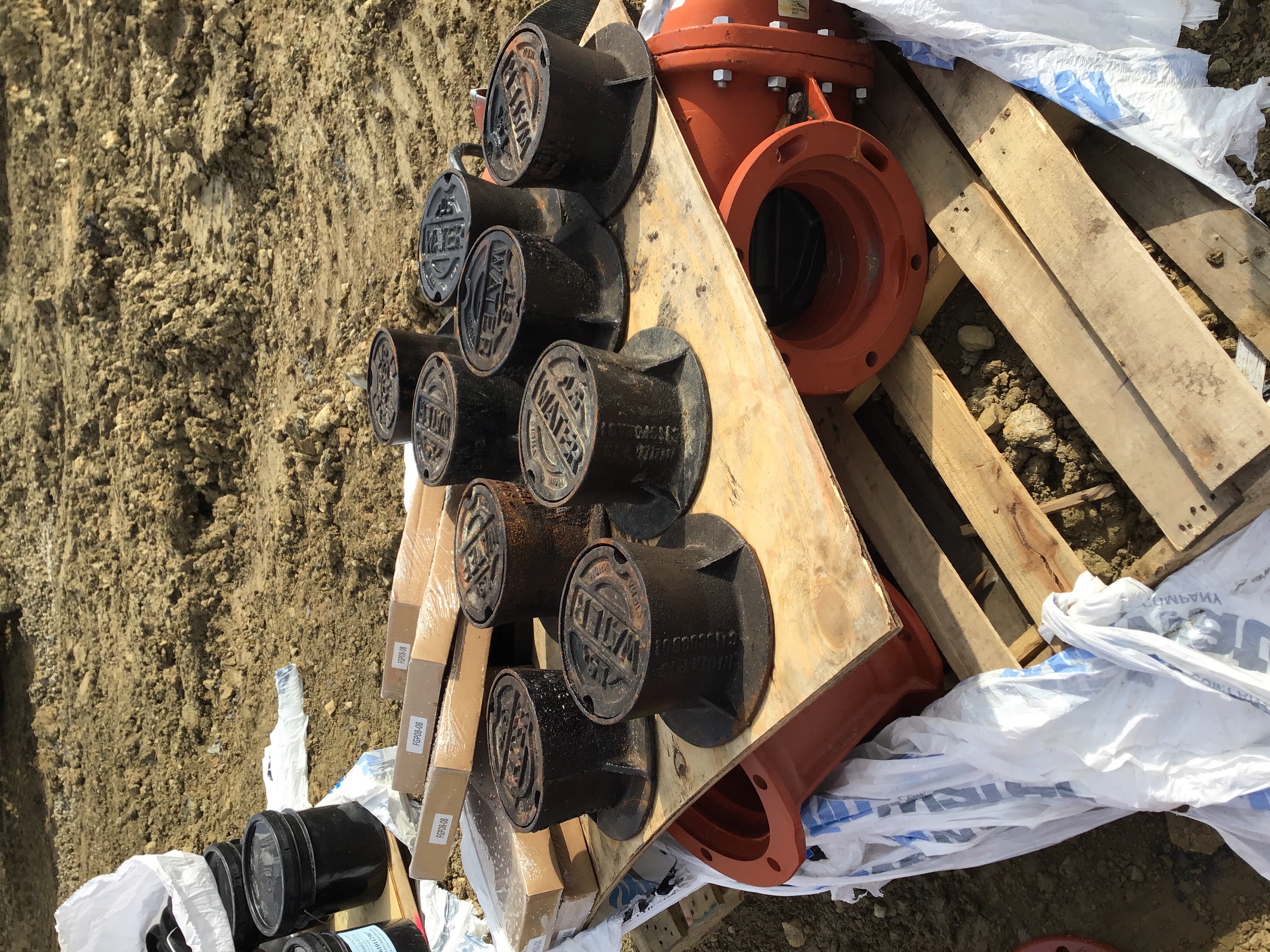

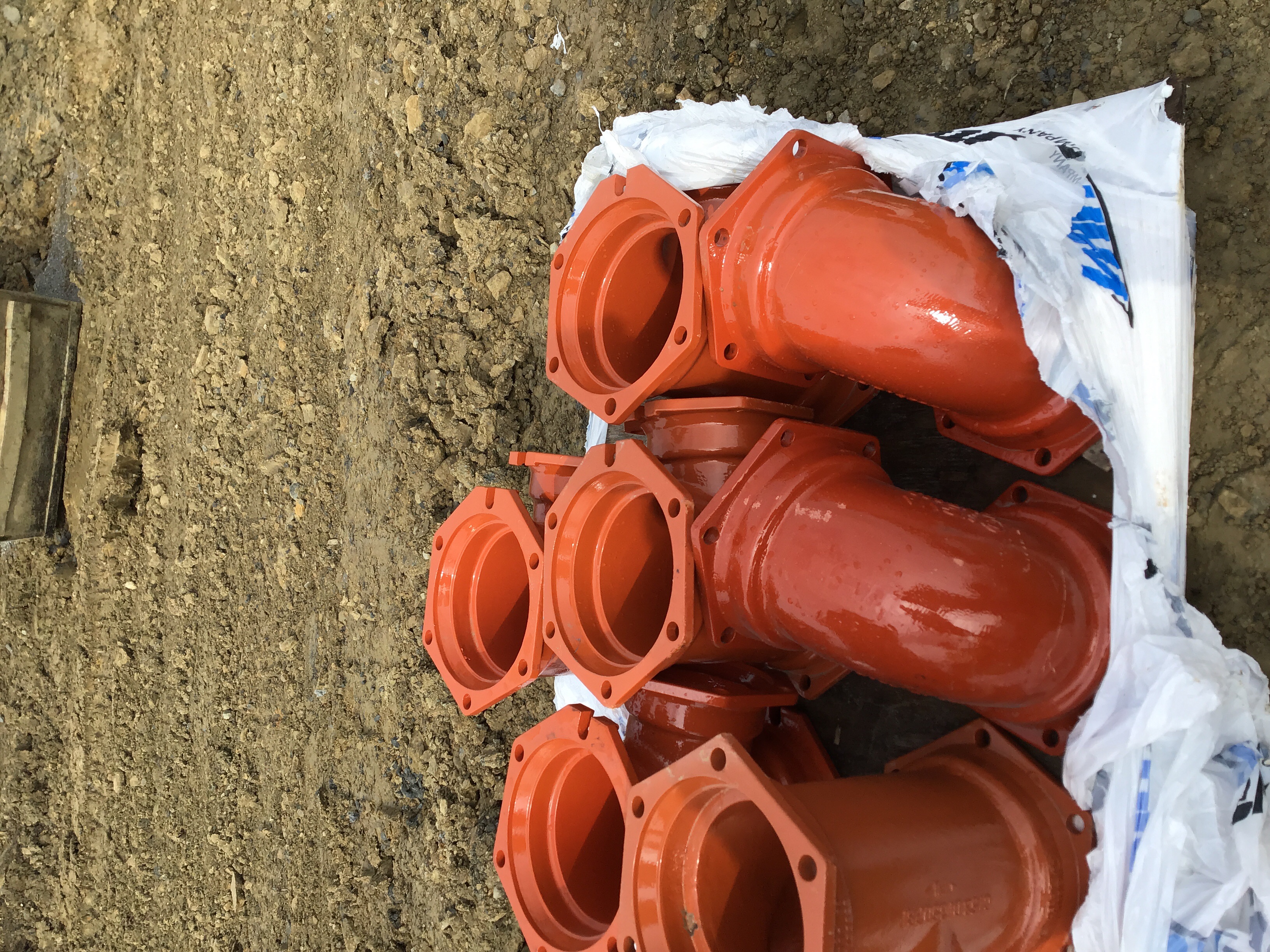

2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Sanitary Sewer Construction Inspection Partial 02/13/2019
Misc
Informational
12/12/2018

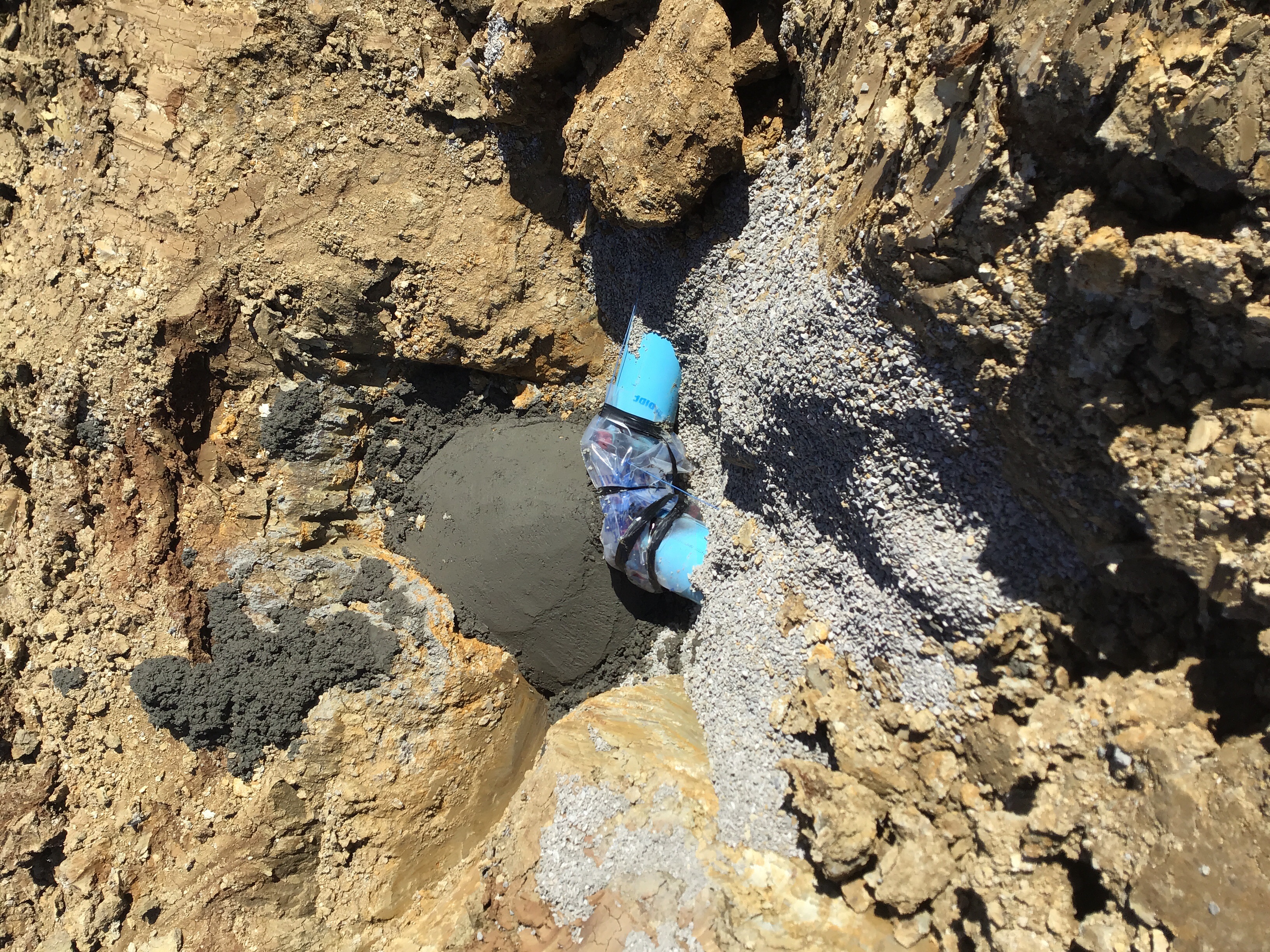

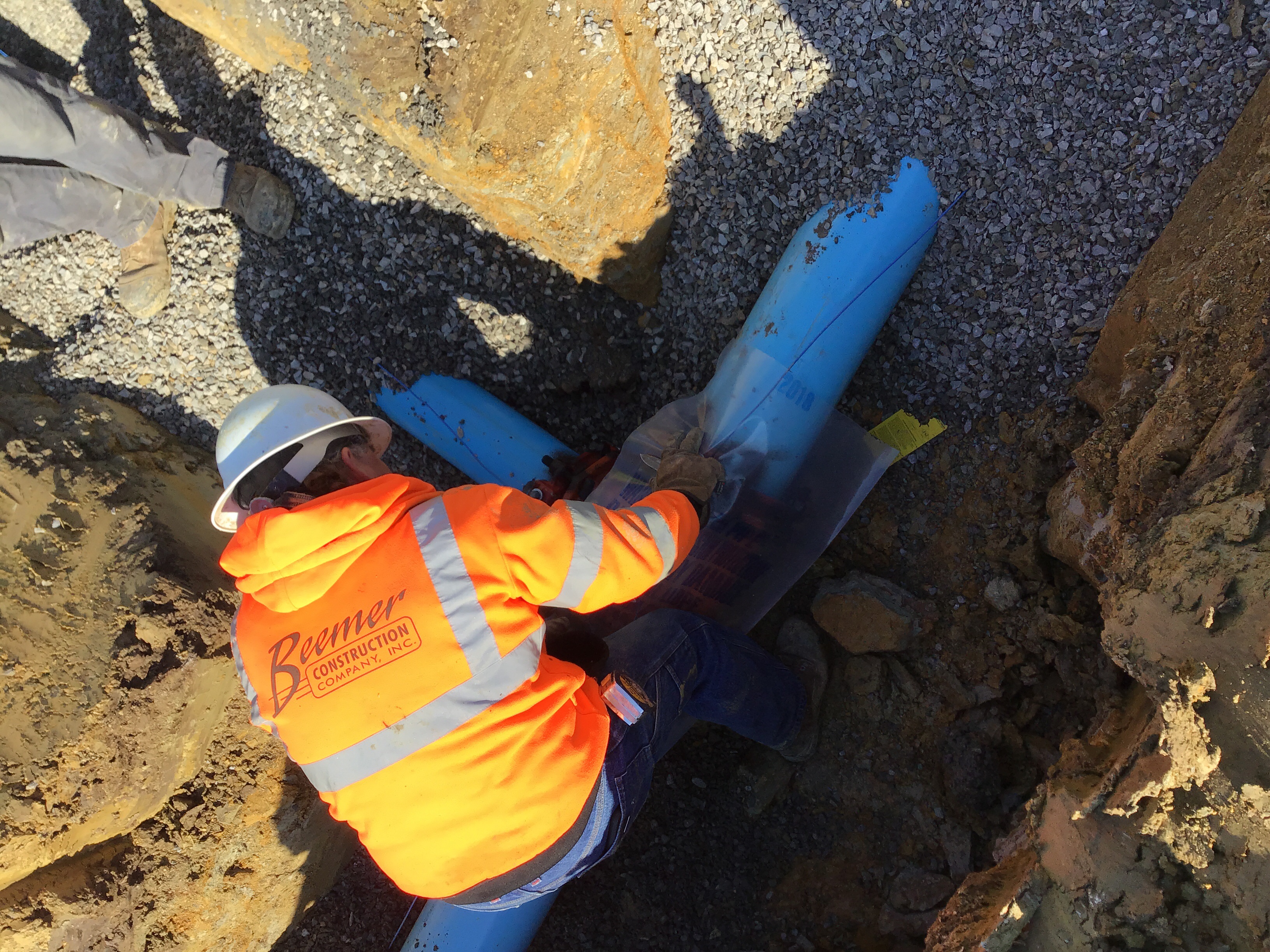

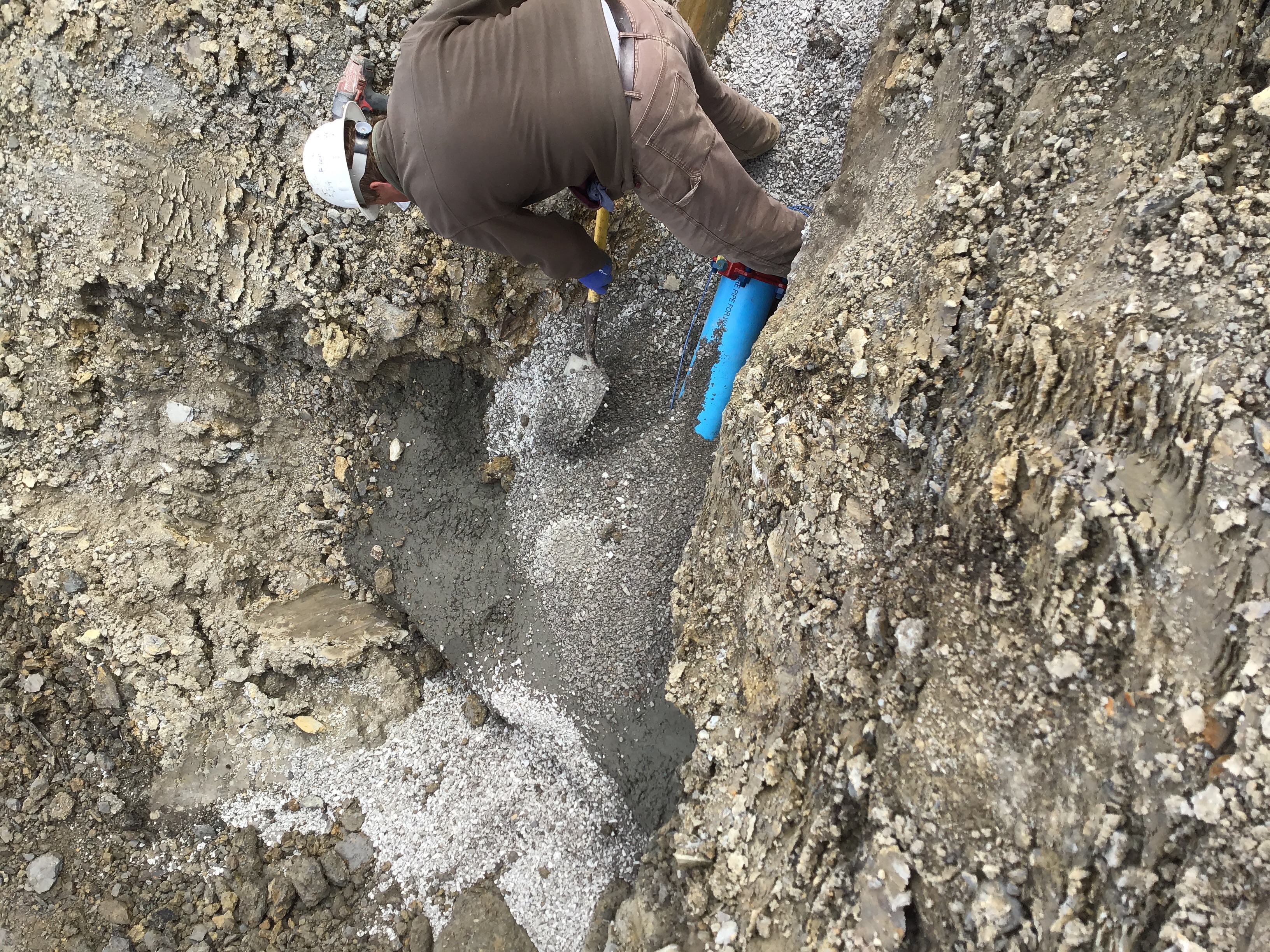

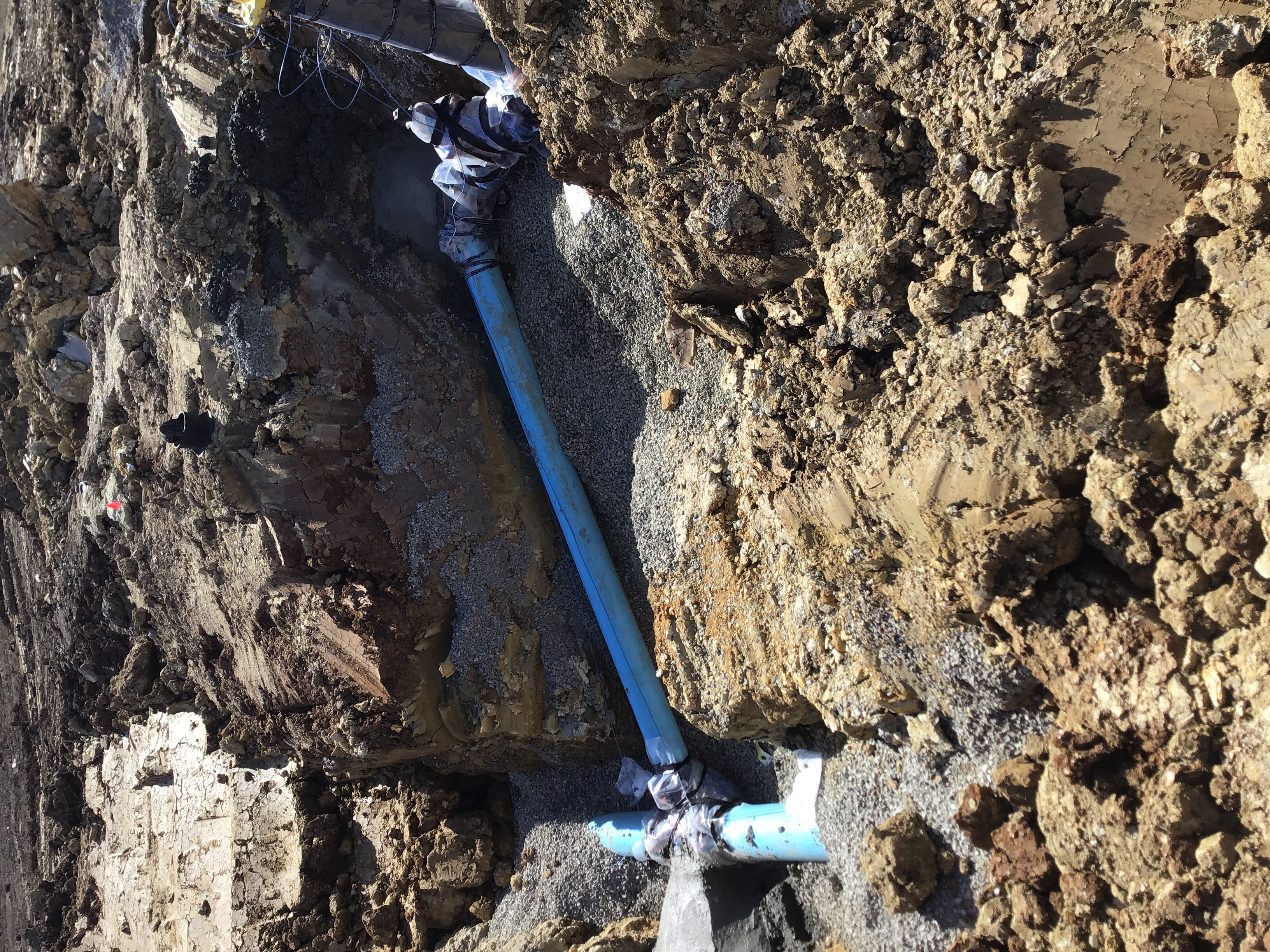

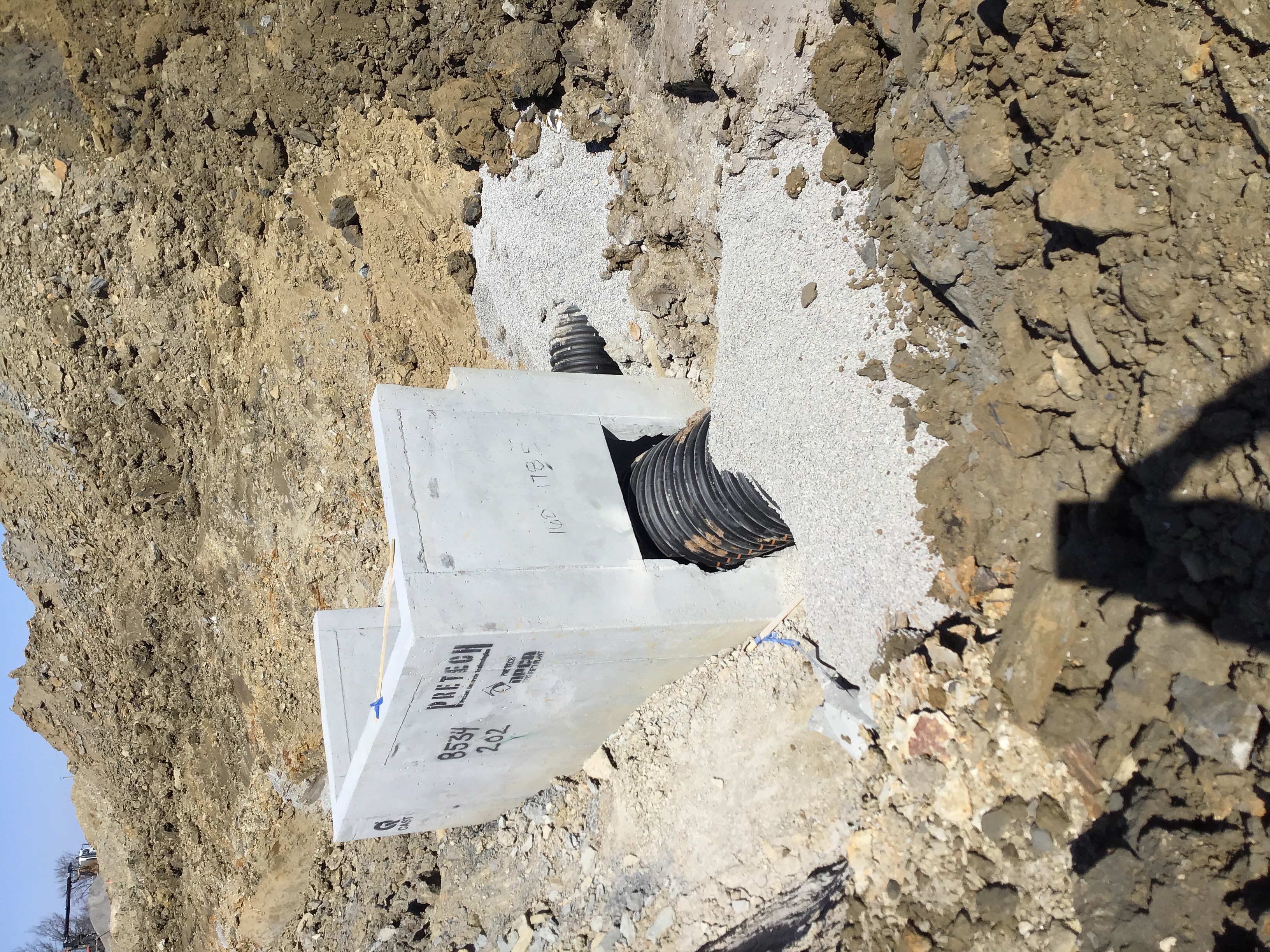

Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
12/12/2018

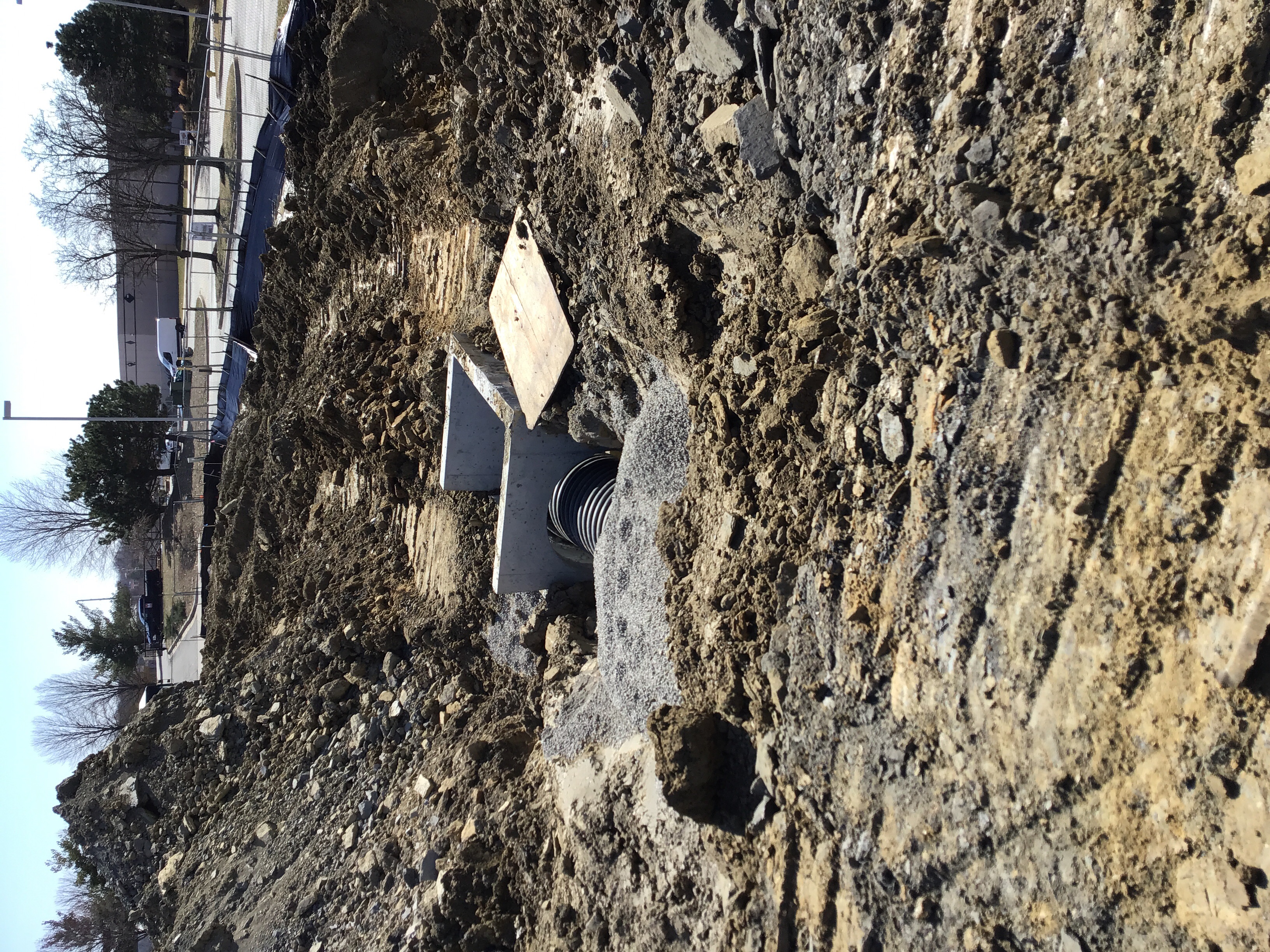

Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
12/12/2018

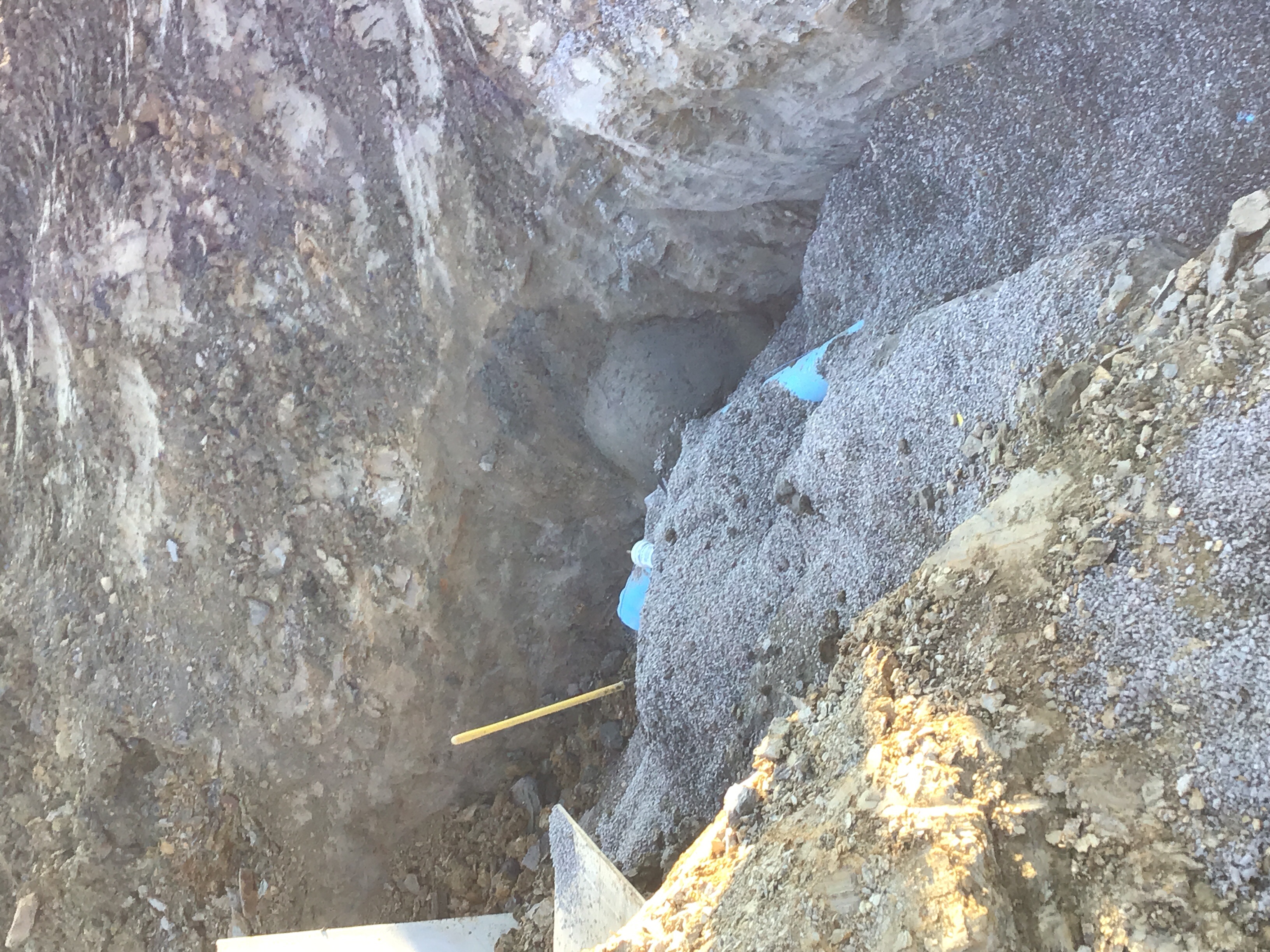

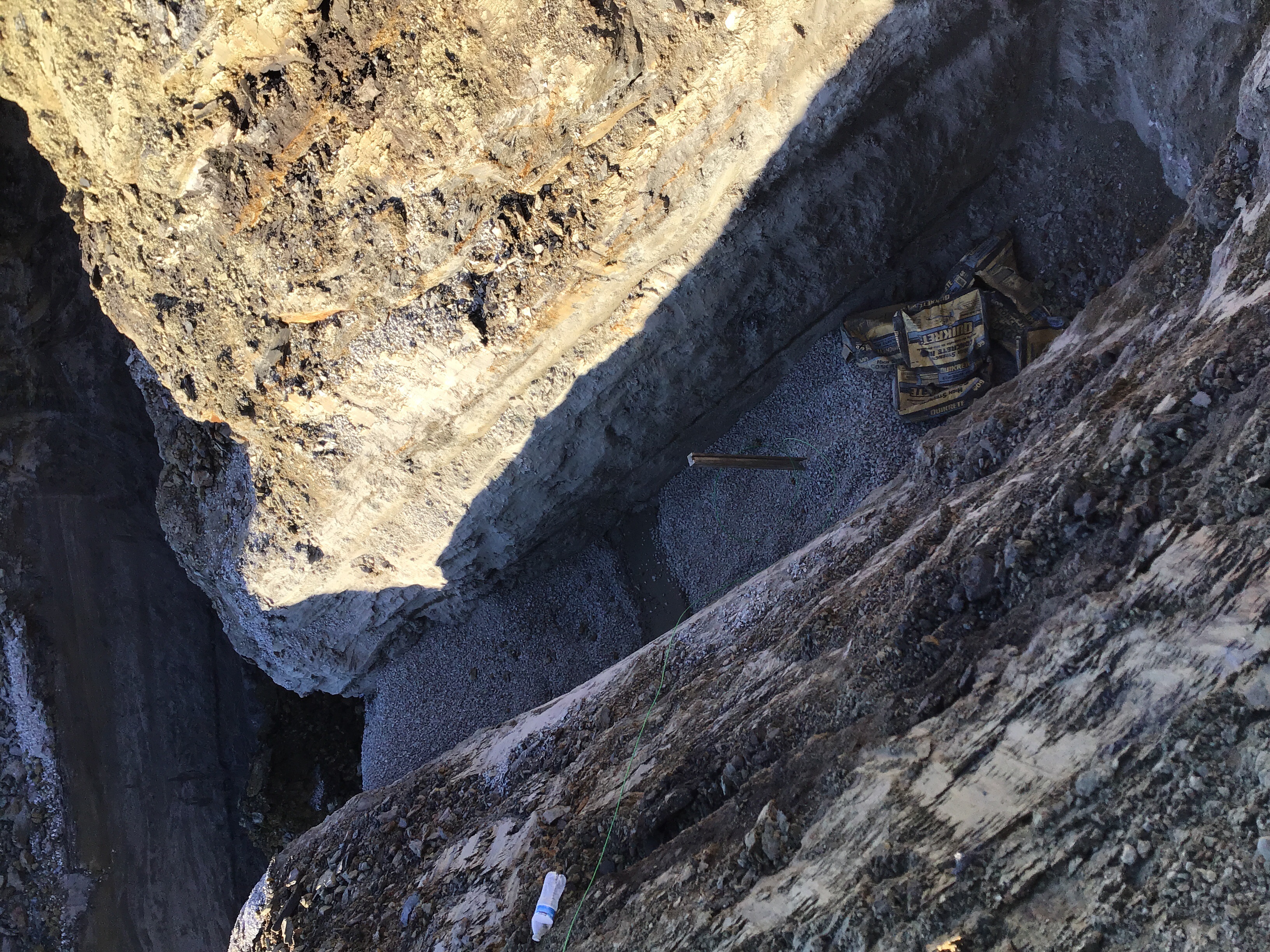

Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Misc
Corrective Action Required
12/12/2018

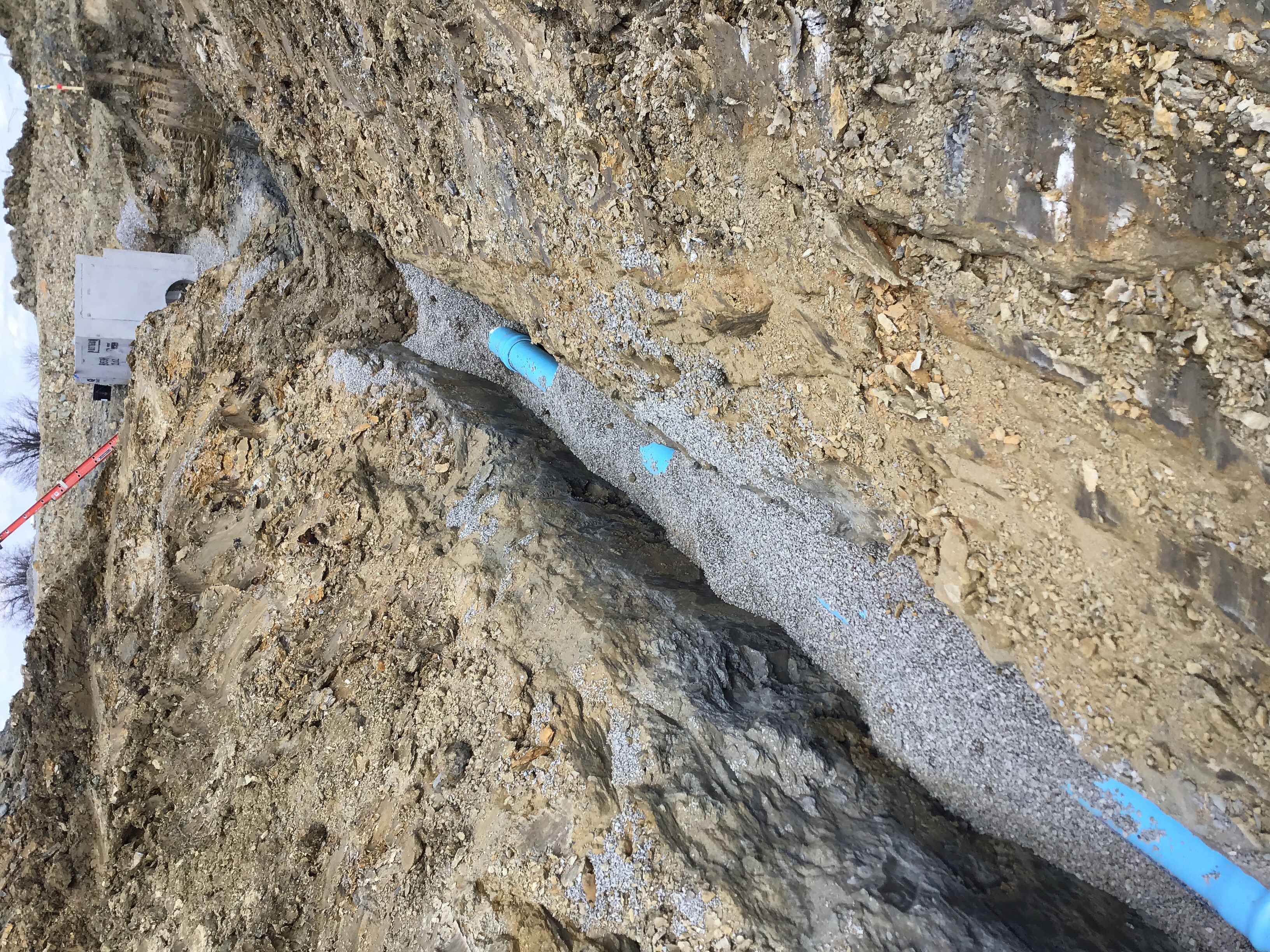

10:30 am Sanitary line has been placed from A-3 to approximately 100 feet past A-4 with service Lines to the east and west installed. Alpha Omega Geotech is on site and doing compaction tests during backfill. 2:40 pm sanitary line has been placed to A-5 with a service line on the east side. One more service line needs to be installed.
Misc
Corrective Action Required
12/12/2018

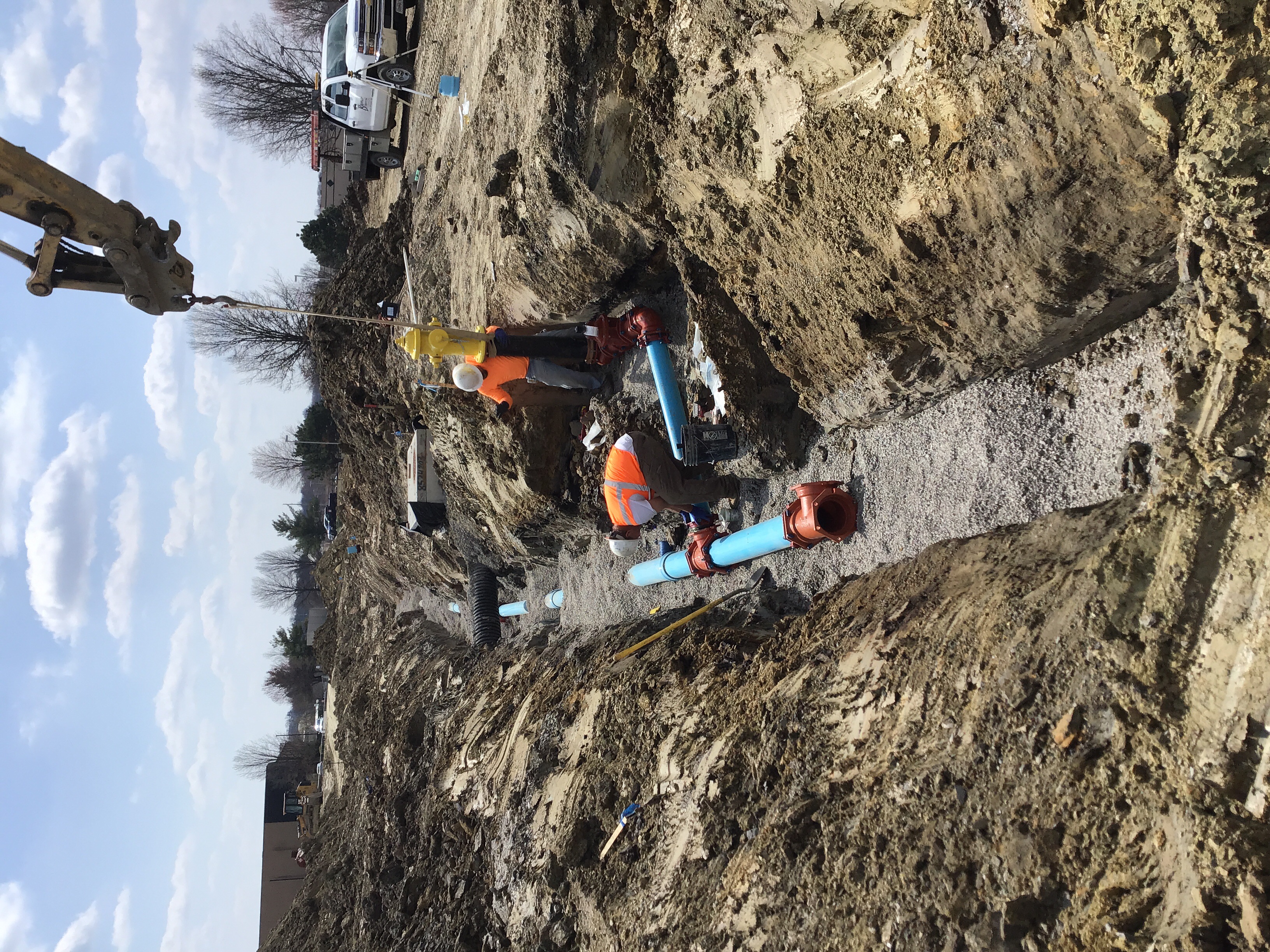

10:40 AM Beemer Construction finished laying sanitary service line and poured two inverts and three trench checks.
Misc
Informational
02/13/2019
2-13-19 The crew at Oak View dug up sanitary line at the north end of manhole A-4 and at A-2 to repair sags in the lines. They are back filled and waiting 30 days for testing.
Site Visit Partial 02/26/2019
Misc
Informational
02/12/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
02/12/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
02/12/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
02/12/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
02/12/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
02/12/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
02/12/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
02/12/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
02/12/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
02/12/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
02/26/2019

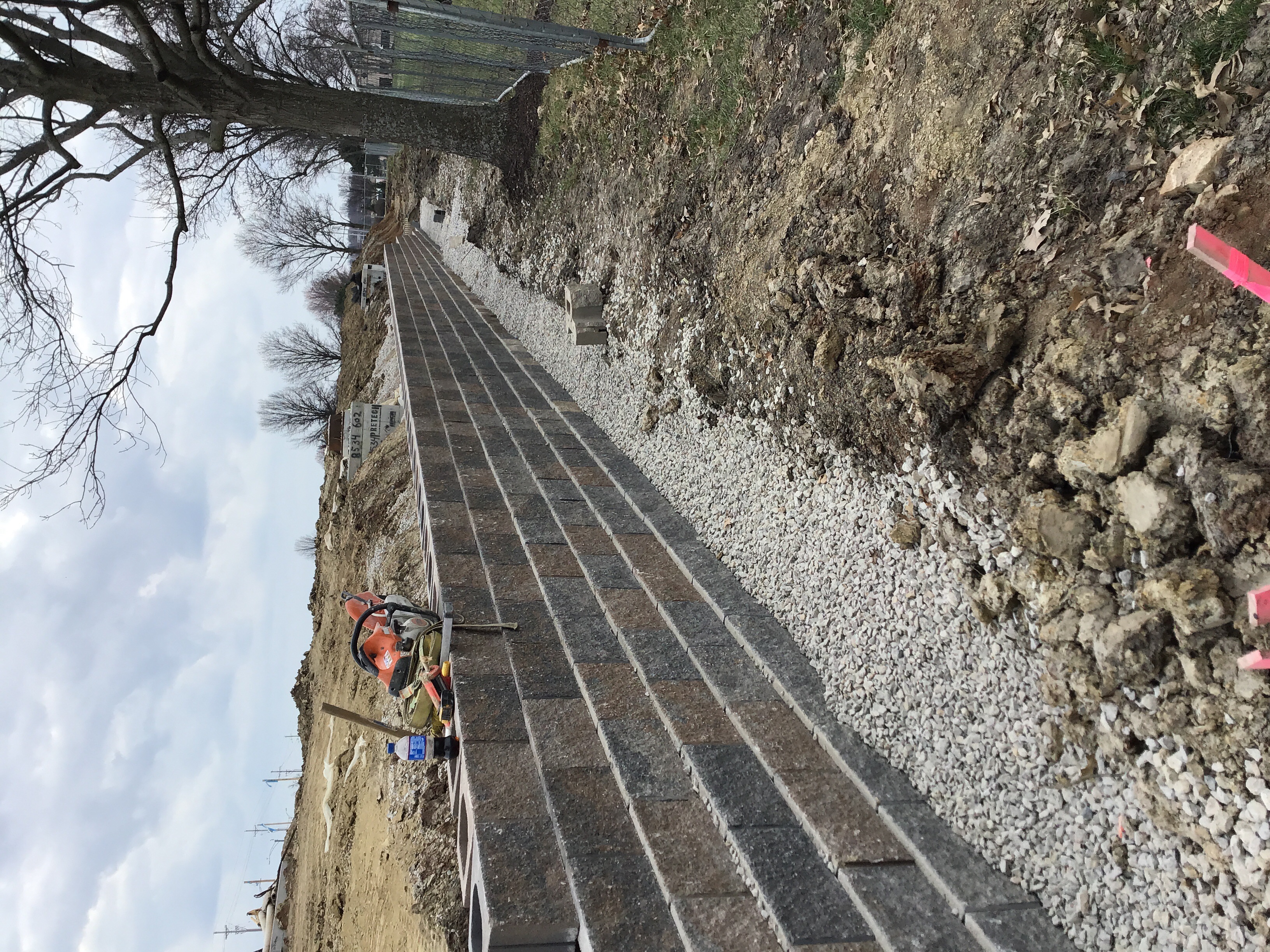

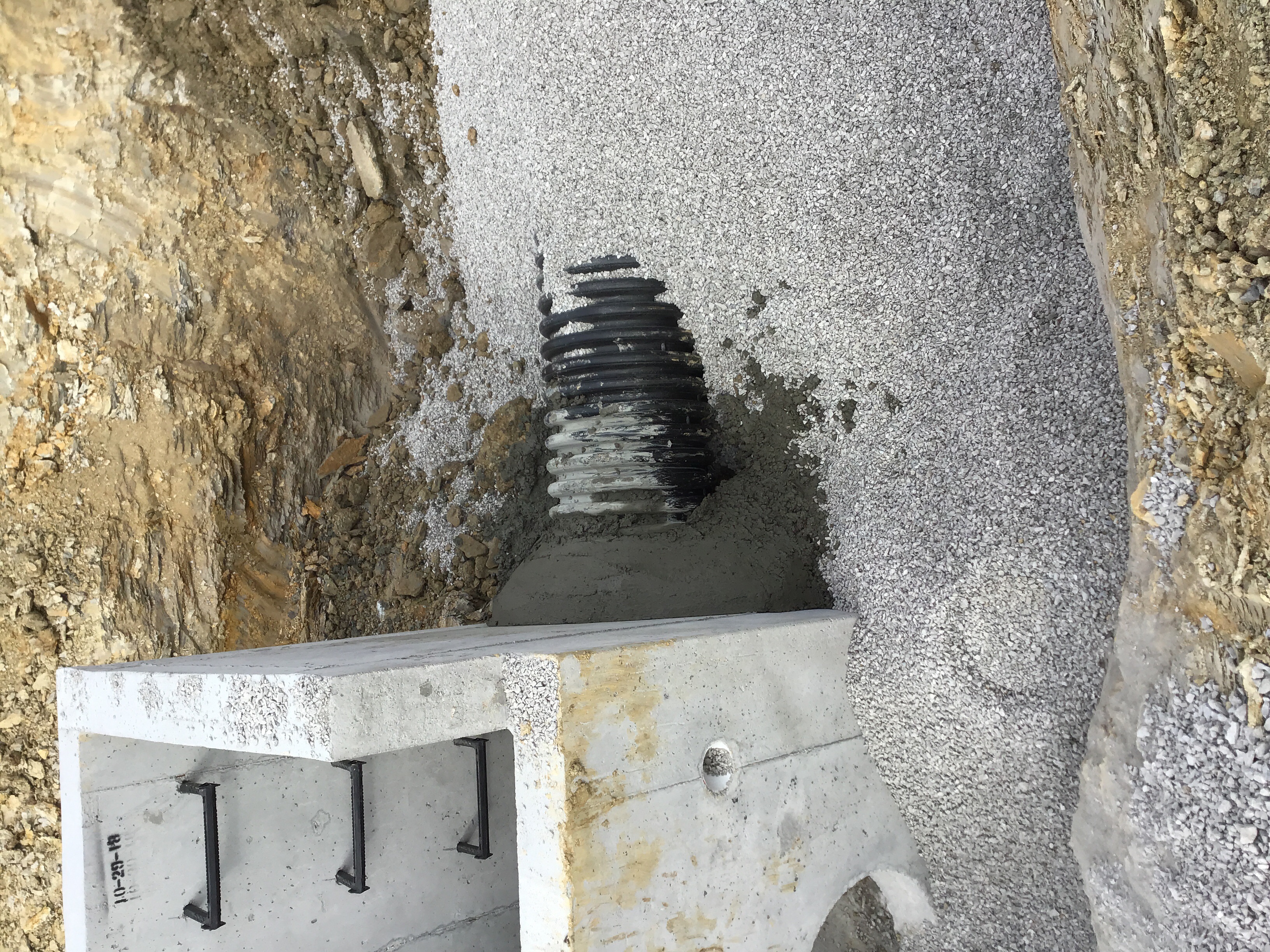

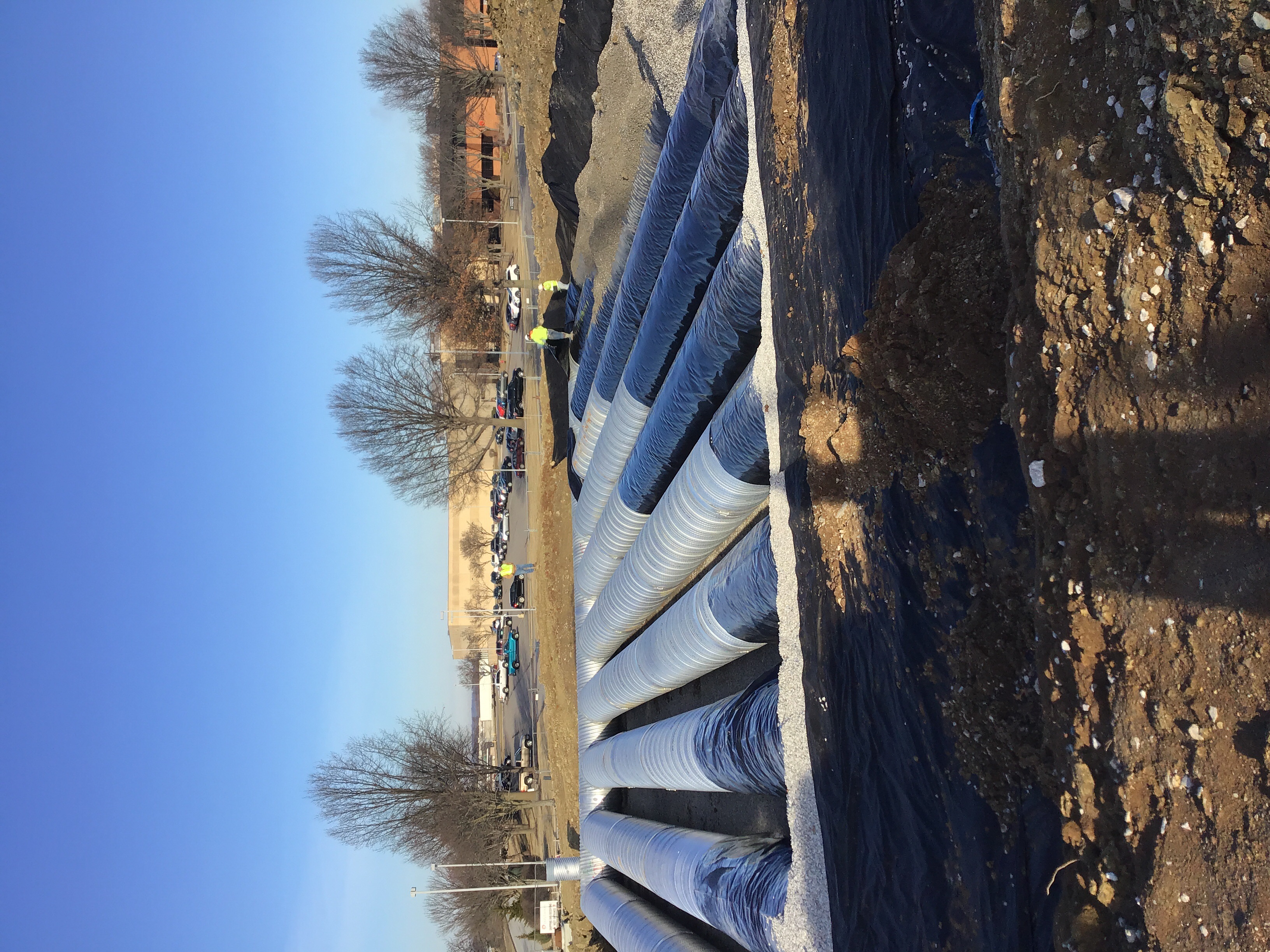

2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Storm Sewer Construction Inspection Partial 02/26/2019
Misc
Informational
02/26/2019

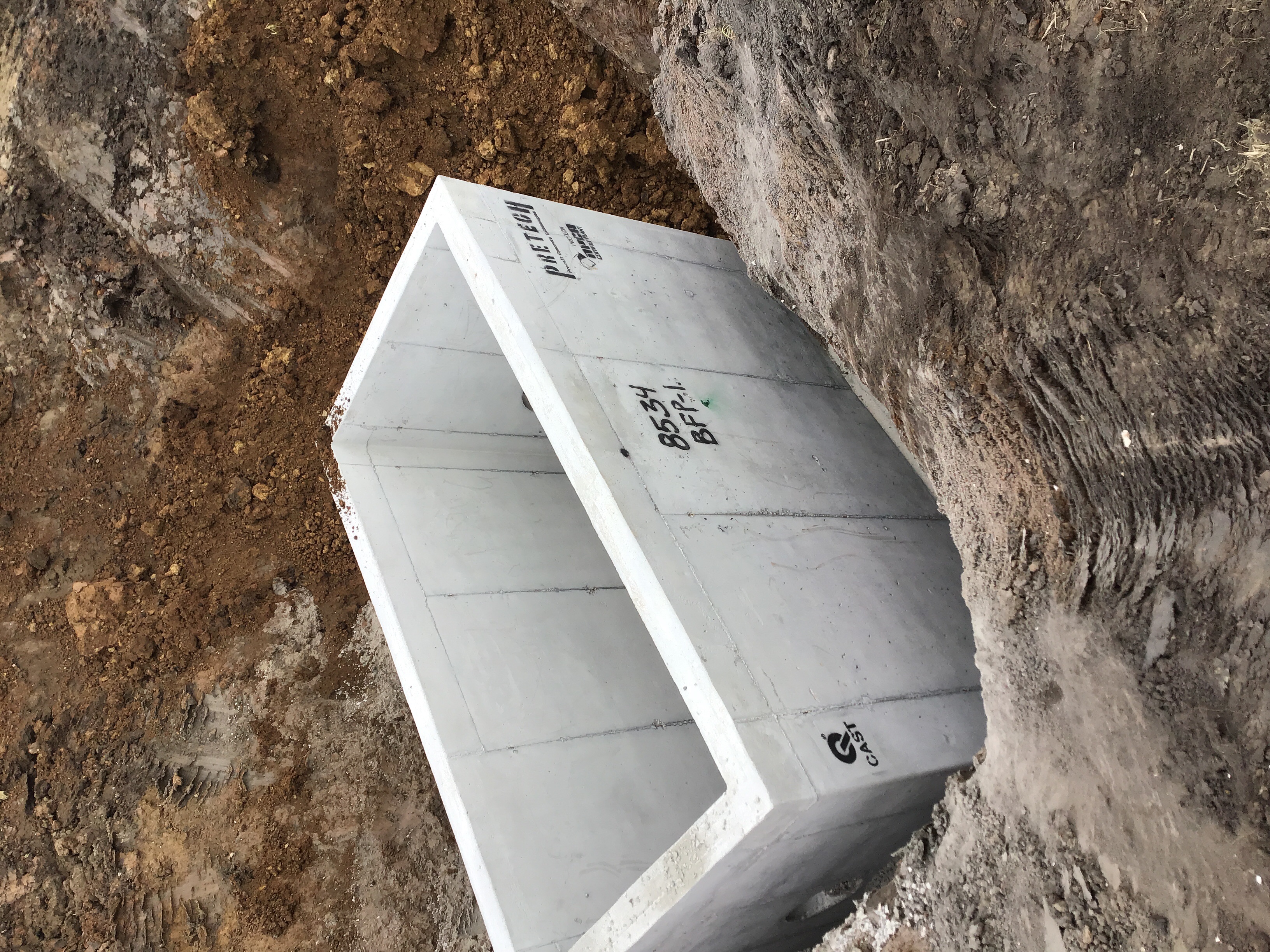

2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.

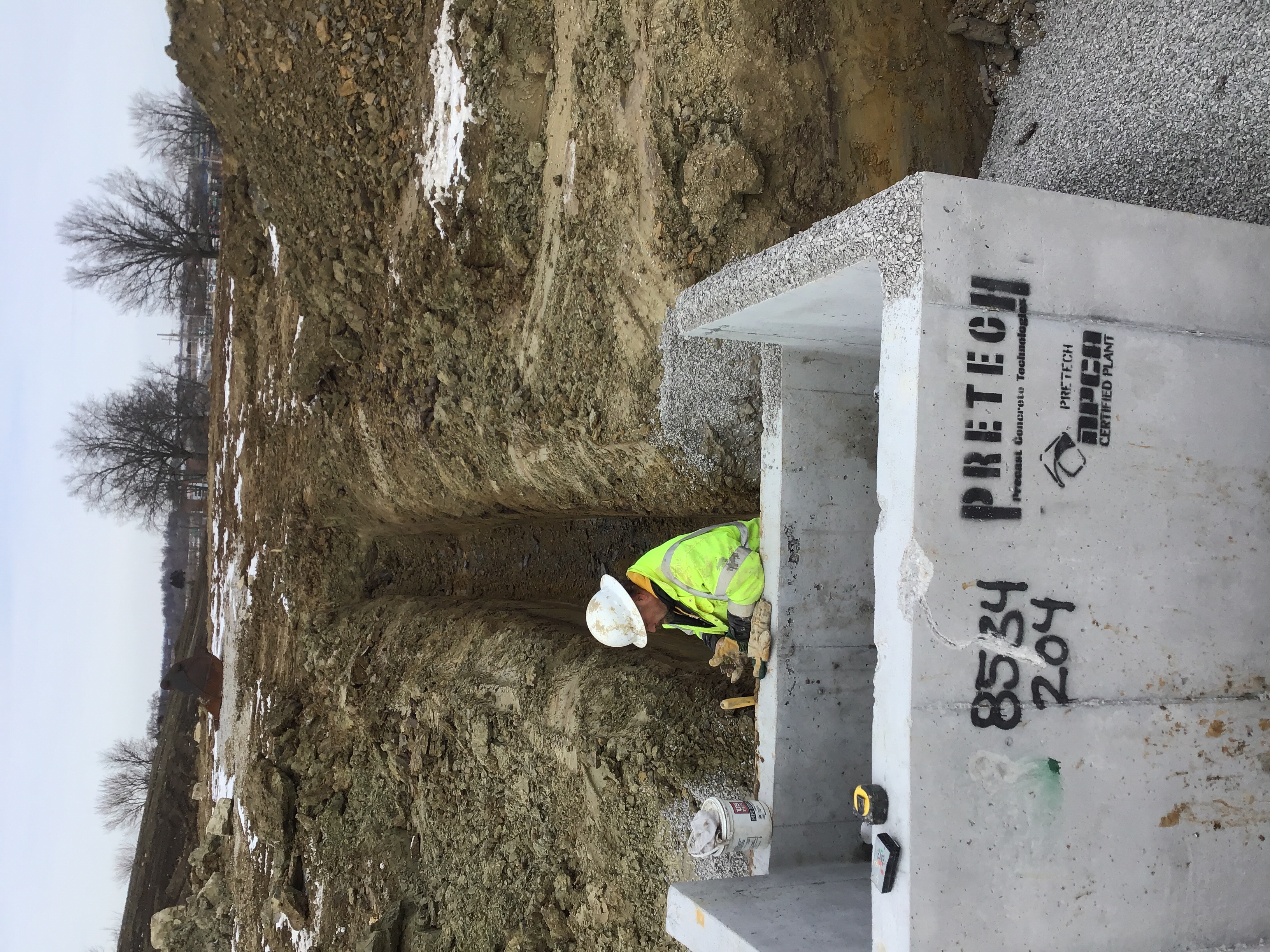

Storm Sewer Construction Inspection Partial 2/26/2019 02/28/2019
Misc
Informational
02/26/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
02/28/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Storm Sewer Construction Inspection Partial 03/01/2019
Misc
Informational
02/28/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
02/28/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/01/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Site Visit Partial 2/12/2019 03/06/2019
Misc
Informational
02/26/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
02/26/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
02/26/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
02/26/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
02/26/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
02/26/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
02/26/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
02/26/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
02/26/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
02/26/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
02/26/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/06/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Storm Sewer Construction Inspection Partial 03/06/2019
Misc
Informational
03/01/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
03/01/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/01/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Misc
Informational
03/06/2019

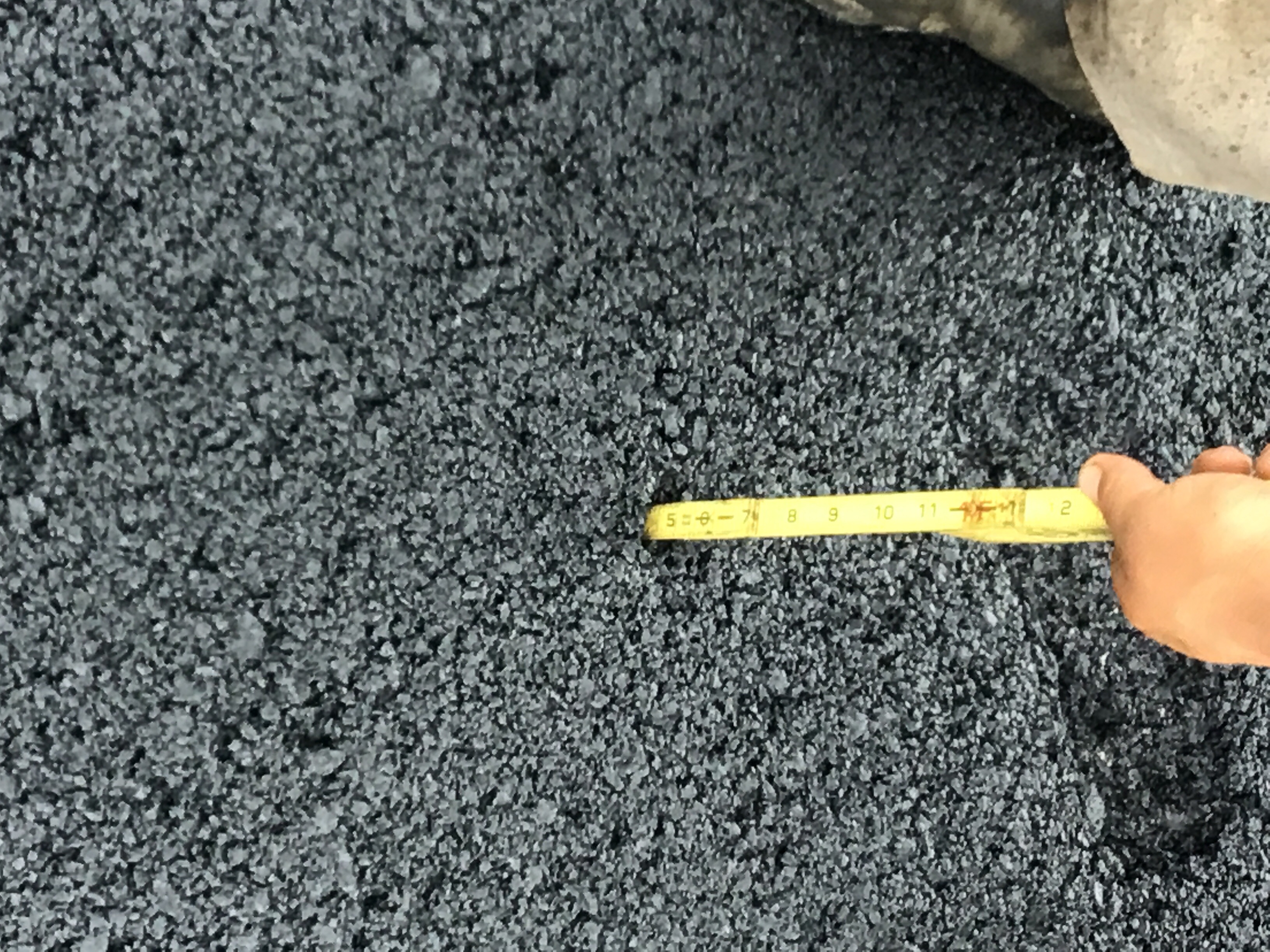

2-6-19 10:10am to 10:45am. The crew has set curb inlet 201-202, 202-203. They have installed storm pipe from 201-202. I returned in the after noon, they set curb inlet 204-205. They installed storm pipe from 203-204 and installed rock and back filled.
Storm Sewer Construction Inspection Partial 3/7/2019 03/07/2019
Misc
Informational
03/06/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
03/06/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/06/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Misc
Informational
03/06/2019
2-6-19 10:10am to 10:45am. The crew has set curb inlet 201-202, 202-203. They have installed storm pipe from 201-202. I returned in the after noon, they set curb inlet 204-205. They installed storm pipe from 203-204 and installed rock and back filled.
Misc
Informational
03/07/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/07/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Site Visit Partial 3/8/2019 03/08/2019
Misc
Informational
03/06/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/06/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/06/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/06/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/06/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/06/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/06/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/06/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/06/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/06/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/06/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/06/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/08/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Sanitary Sewer - Invert Passed 3/7/2019 at 10:00 AM 03/11/2019
Misc
Informational
12/20/2018

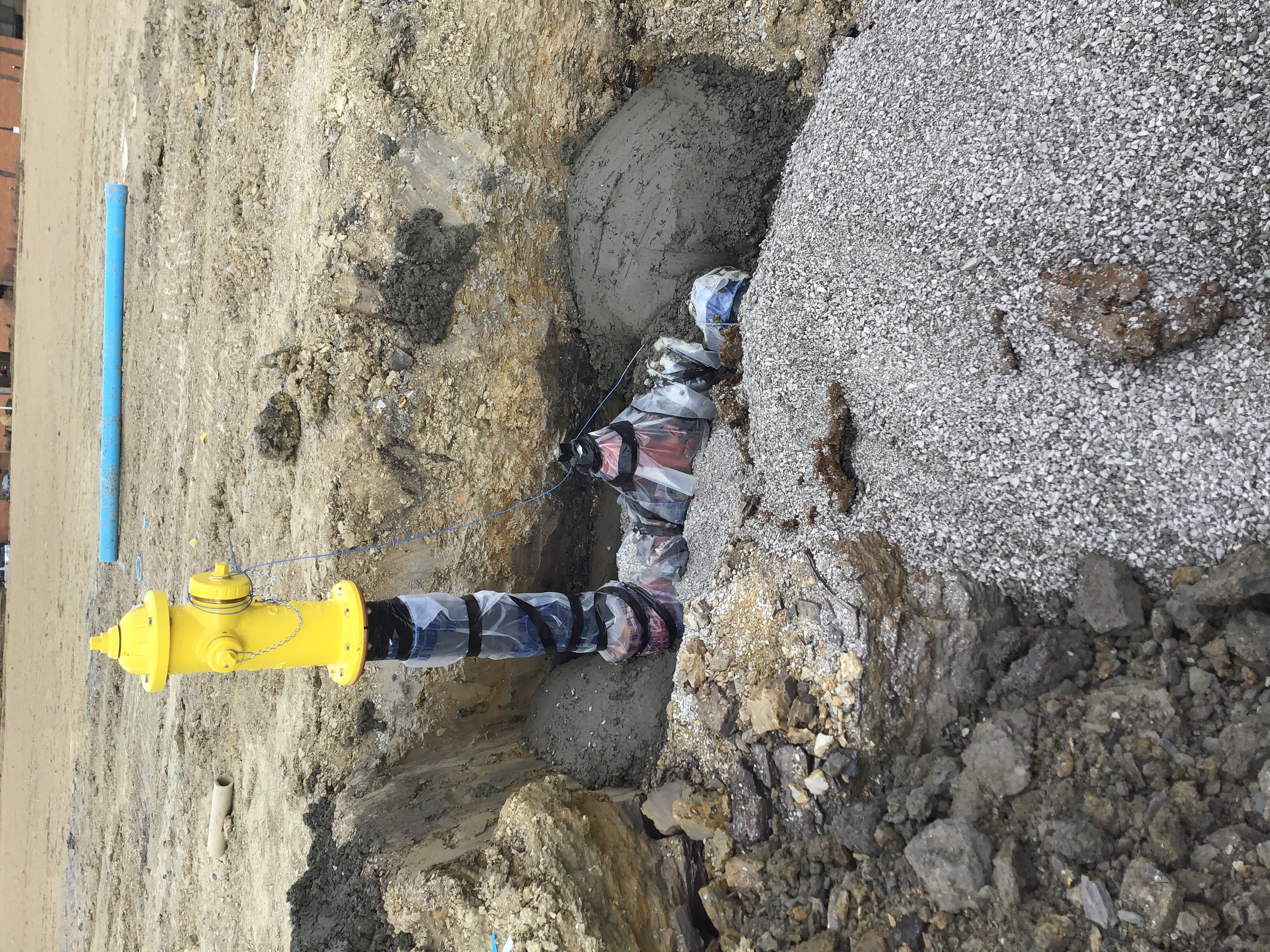

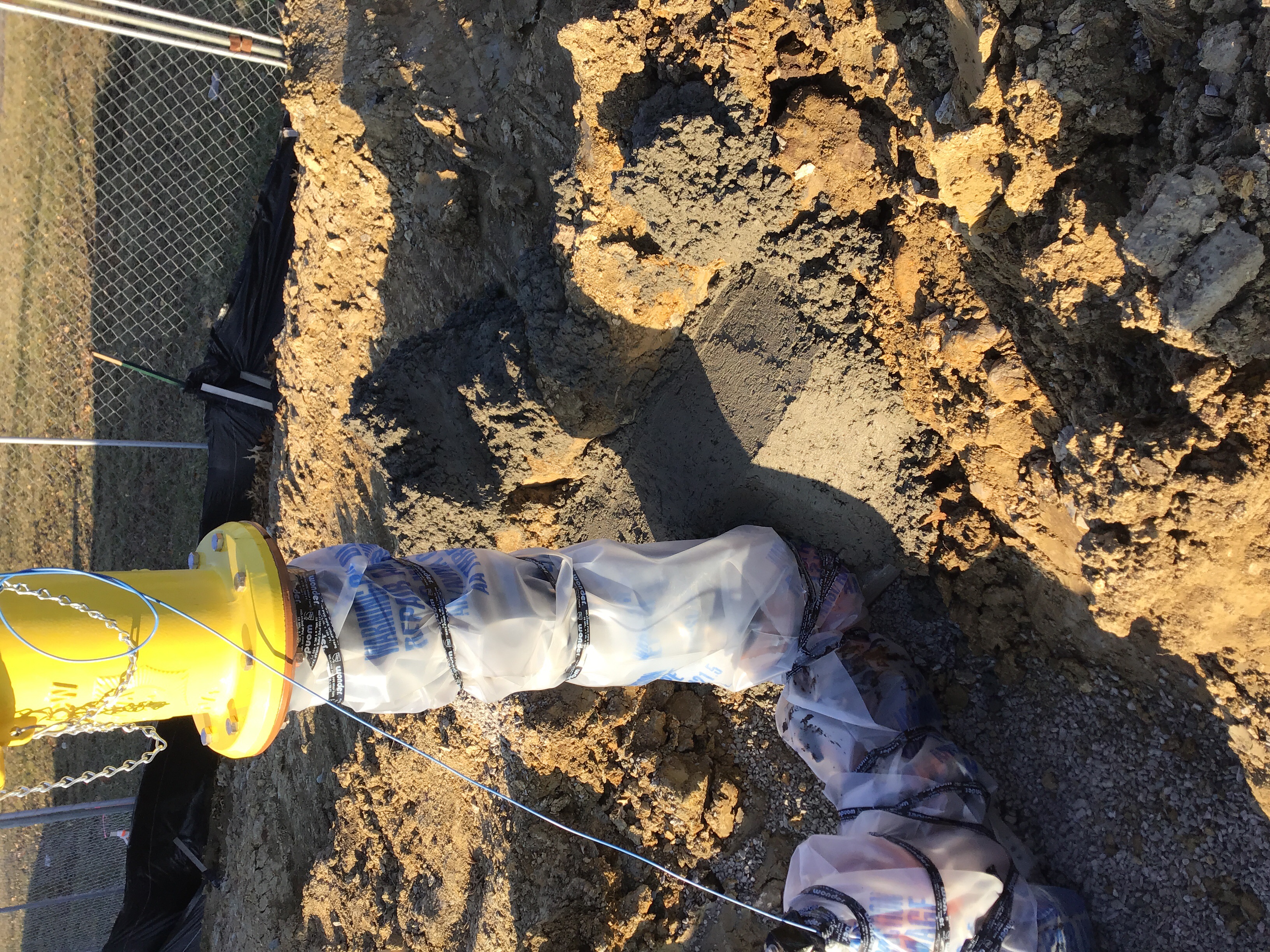

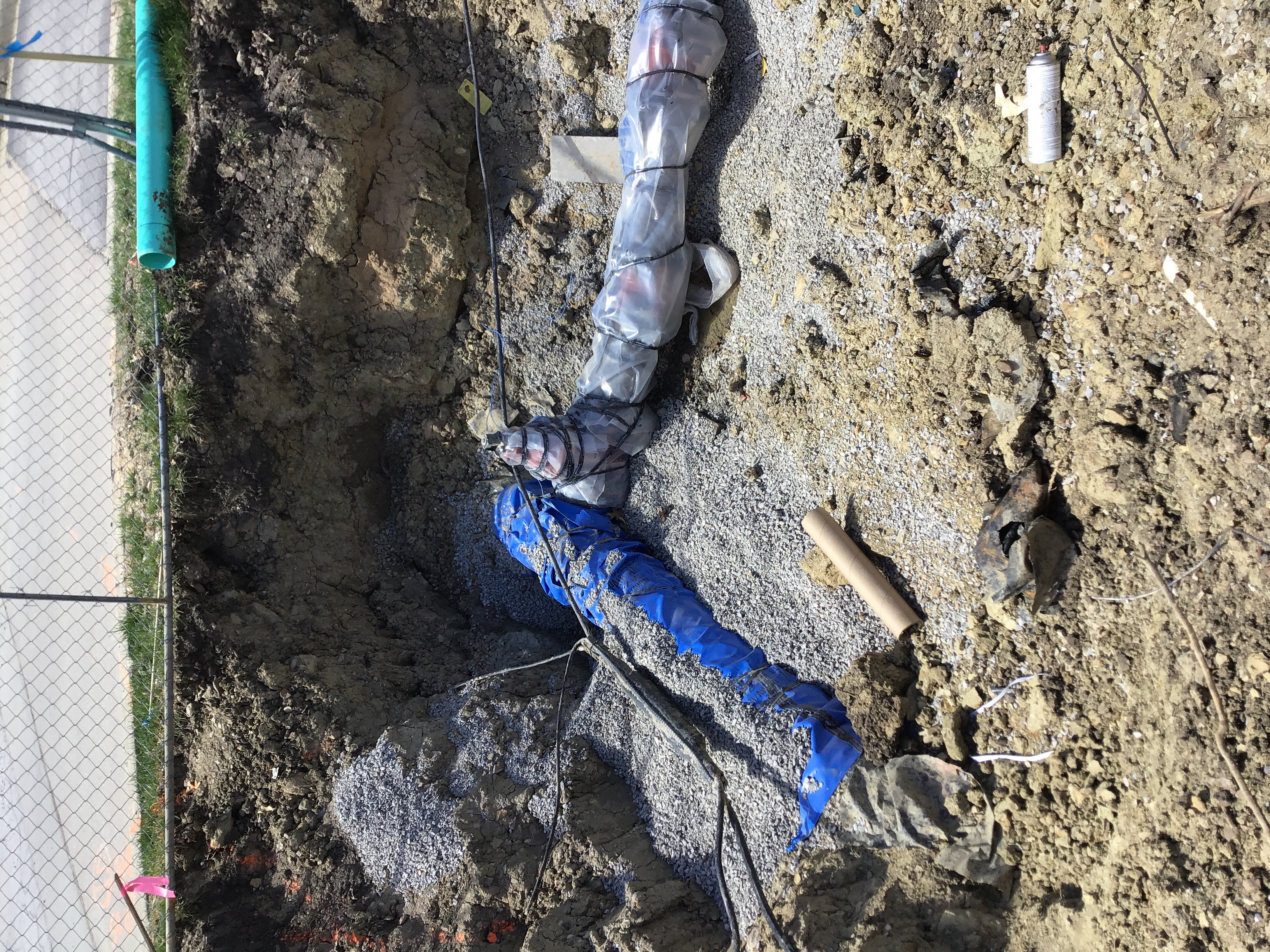

12/19/18 Manhole A-1 through A-5 inverts are good. Existing manhole invert will need some modification.
Misc
Informational
03/11/2019

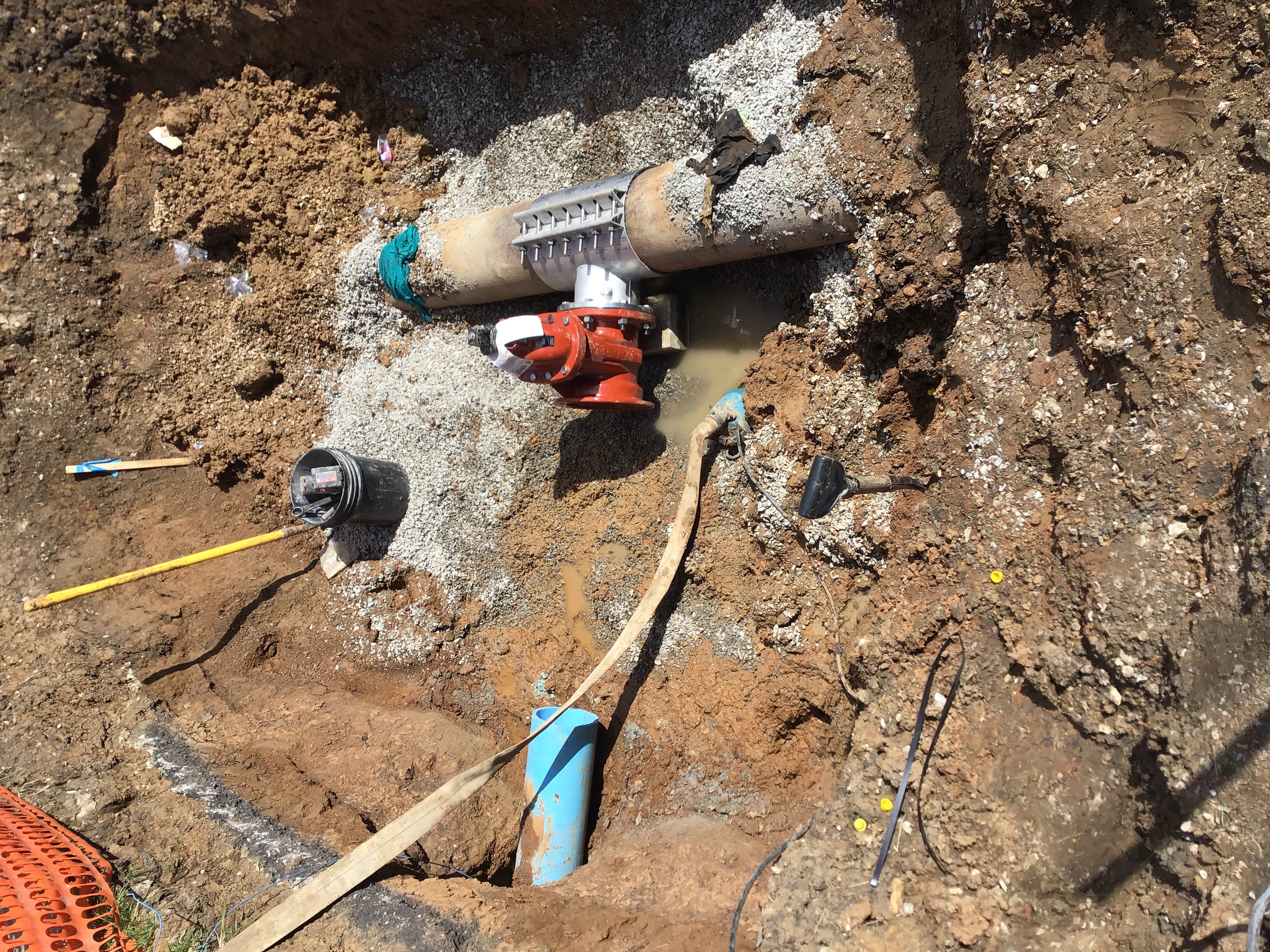

Joe Starlin 03/11/2019 8:11 AM The existing manhole invert has been corrected and verified by myself and Steve Robbins.
Detention Basin Partial 1/7/2019 03/11/2019
Misc
Informational
01/11/2019

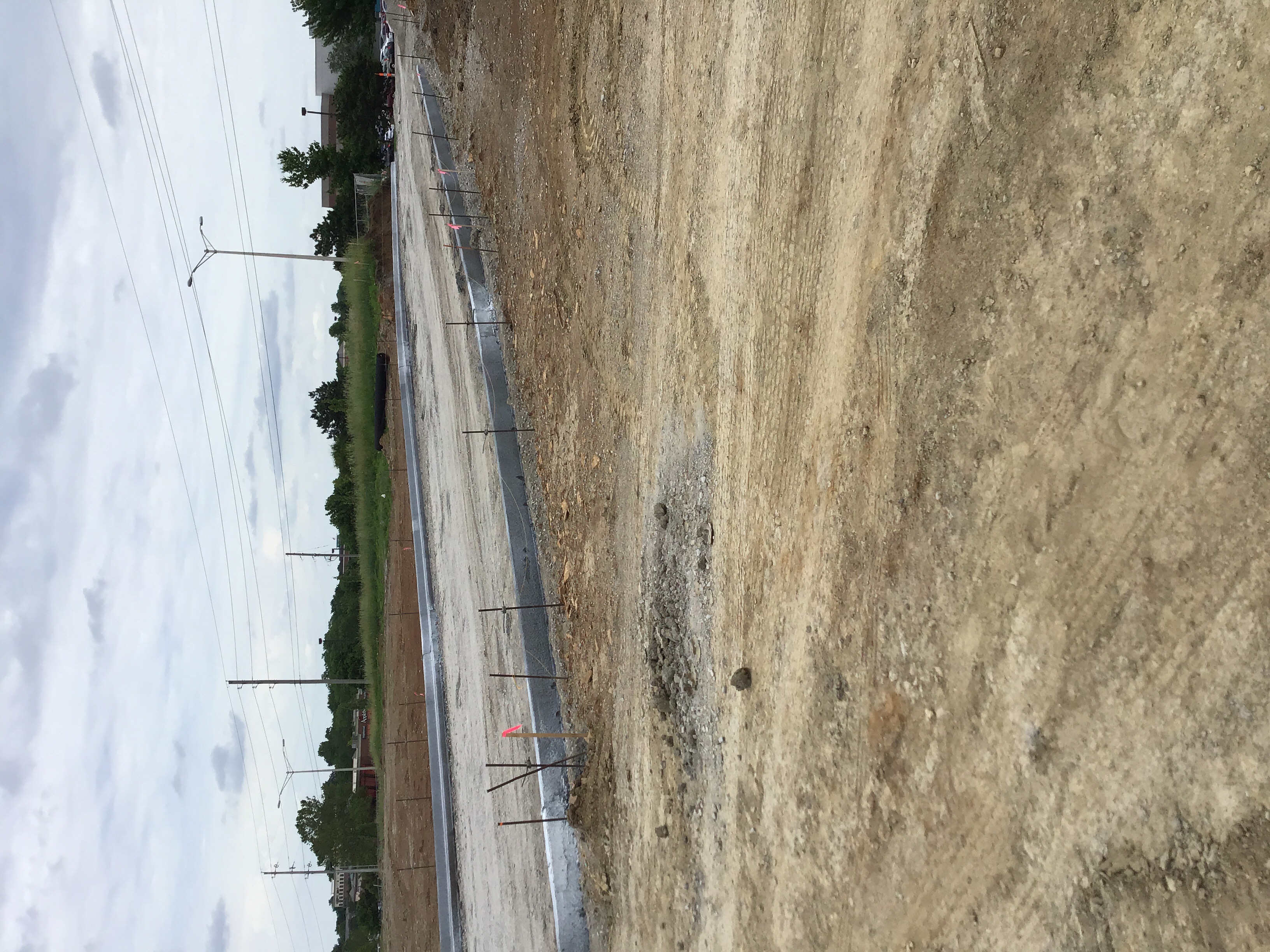

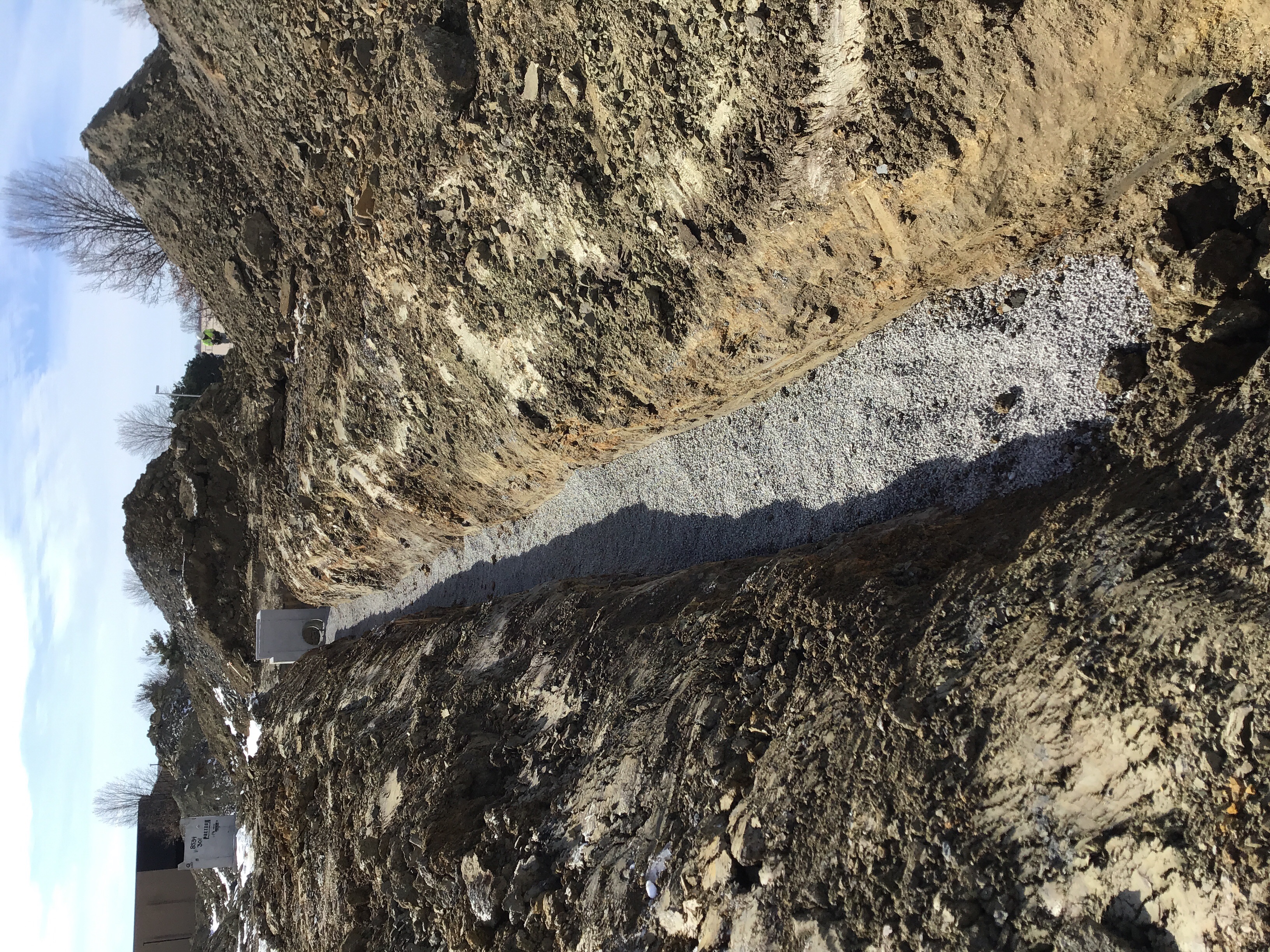

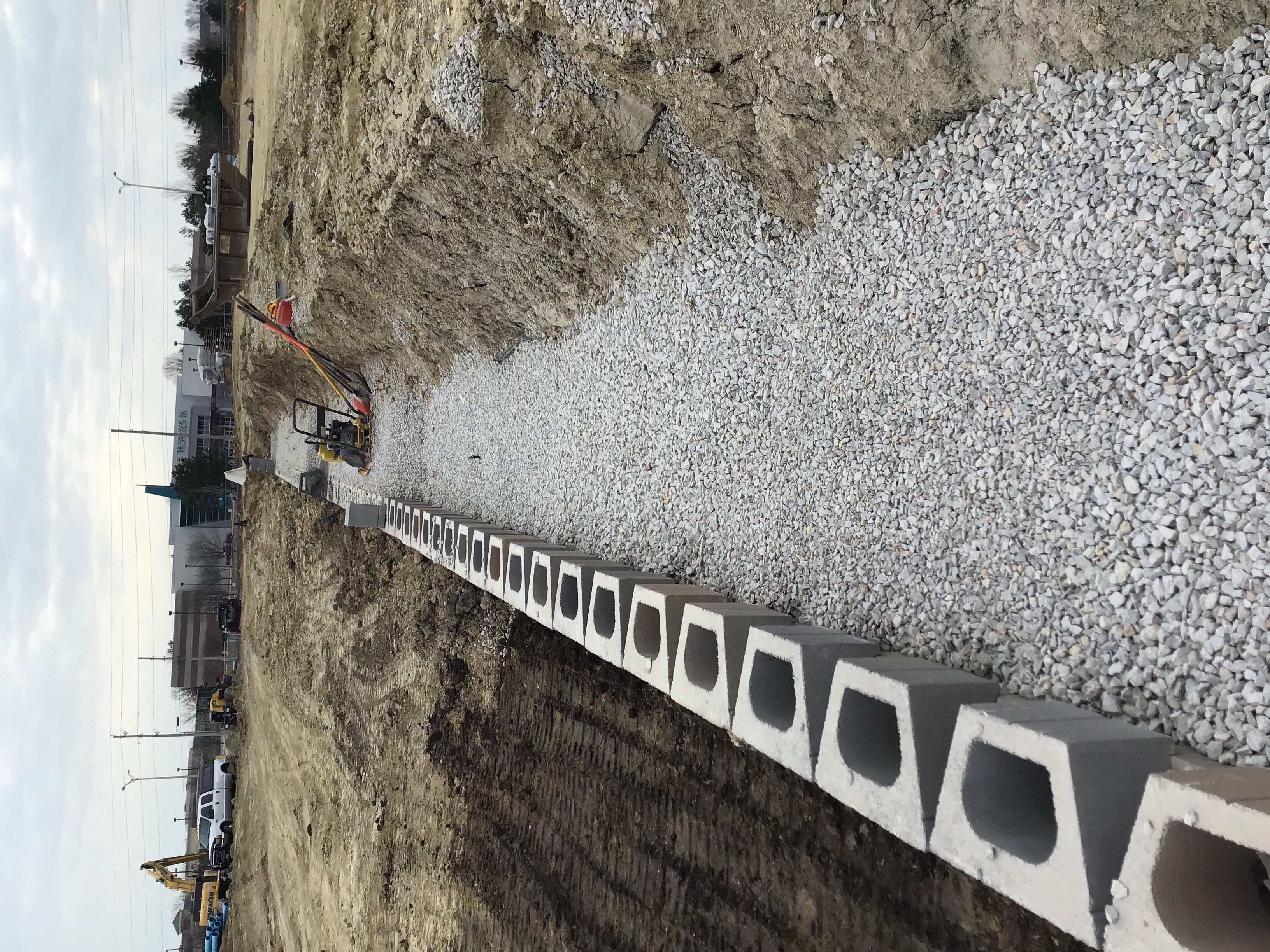

The 13,673 cu. ft. underground detention system has been installed and covered. The inspector for Contech Engineered Solutions John Willhoite was on site daily for the installation. He will be sending a report on the detention system.
Misc
Informational
03/11/2019
3-11-19 The Beemer crew are currently backfilling the underground detention on the south side of site. The third party inspector is on site.
Site Visit Partial 03/12/2019
Misc
Informational
03/08/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/08/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/08/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/08/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/08/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/08/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/08/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/08/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/08/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/08/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/08/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/08/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/08/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/12/2019

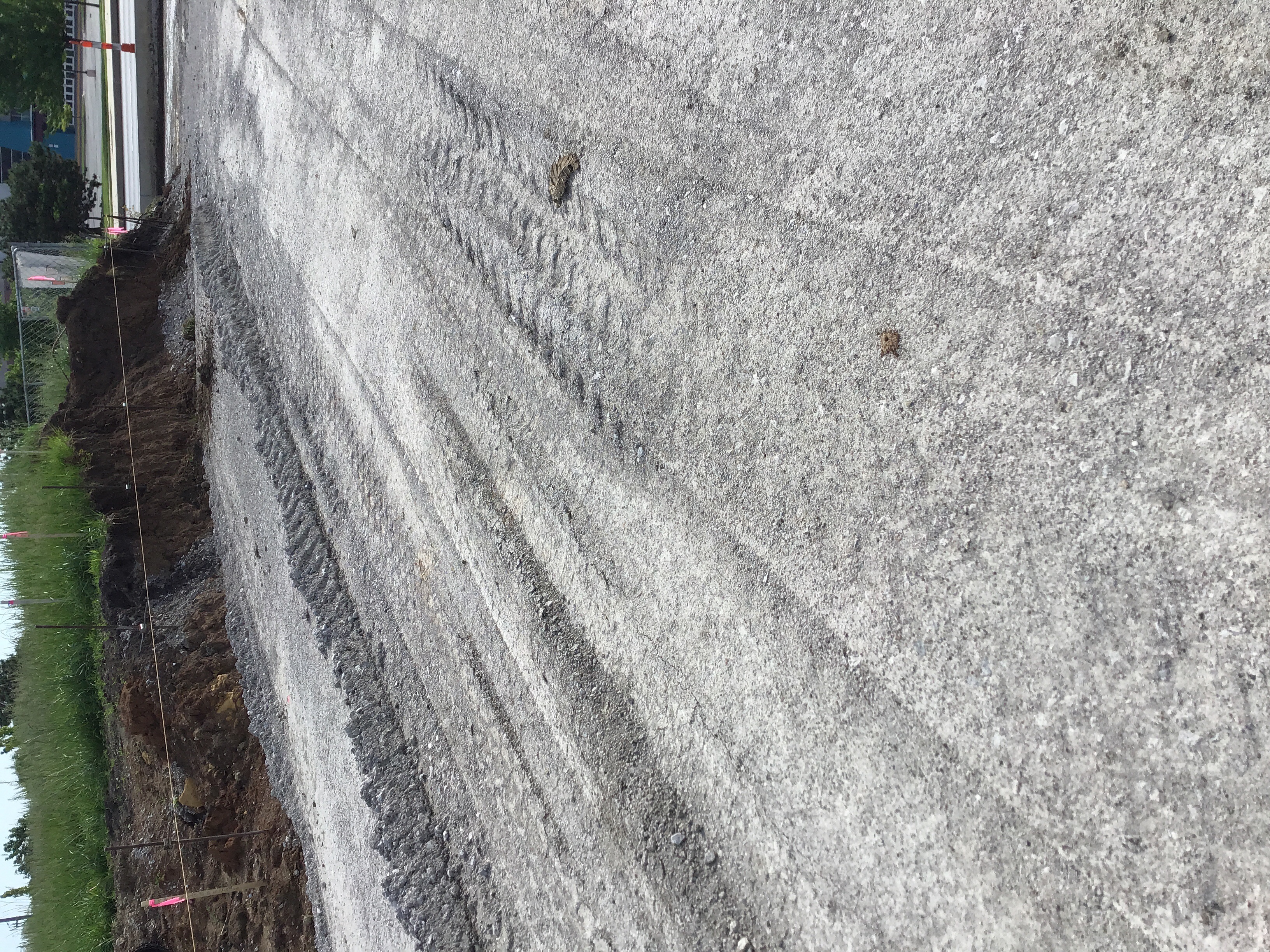

3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Site Visit Partial 03/14/2019
Misc
Informational
03/12/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/12/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/12/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/12/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/12/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/12/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/12/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/12/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/12/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/12/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/12/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/12/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/12/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/12/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/14/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Site Visit Partial 03/15/2019
Misc
Informational
03/14/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/14/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/14/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/14/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/14/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/14/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/14/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/14/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/14/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/14/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/14/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/14/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/14/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/14/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/14/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
03/15/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Sanitary Sewer - Mandrel Passed 3/18/2019 at 12:00 PM 03/19/2019
Misc
Informational
03/19/2019
Joe Starlin 03/19/2019 7:23 AM The crew ran the mandrel through the sanitary lines that where repaired for sags. Manhole 1 and manhole 4.
Site Visit Partial 3/19/2019 at 9:30 AM 03/19/2019
Misc
Informational
03/15/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/15/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/15/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/15/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/15/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/15/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/15/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/15/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/15/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/15/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/15/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/15/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/15/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/15/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/15/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
03/15/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
03/19/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Site Visit Partial 03/20/2019
Misc
Informational
03/19/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/19/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/19/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/19/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/19/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/19/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/19/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/19/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/19/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/19/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/19/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/19/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/19/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/19/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/19/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
03/19/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
03/19/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
03/20/2019

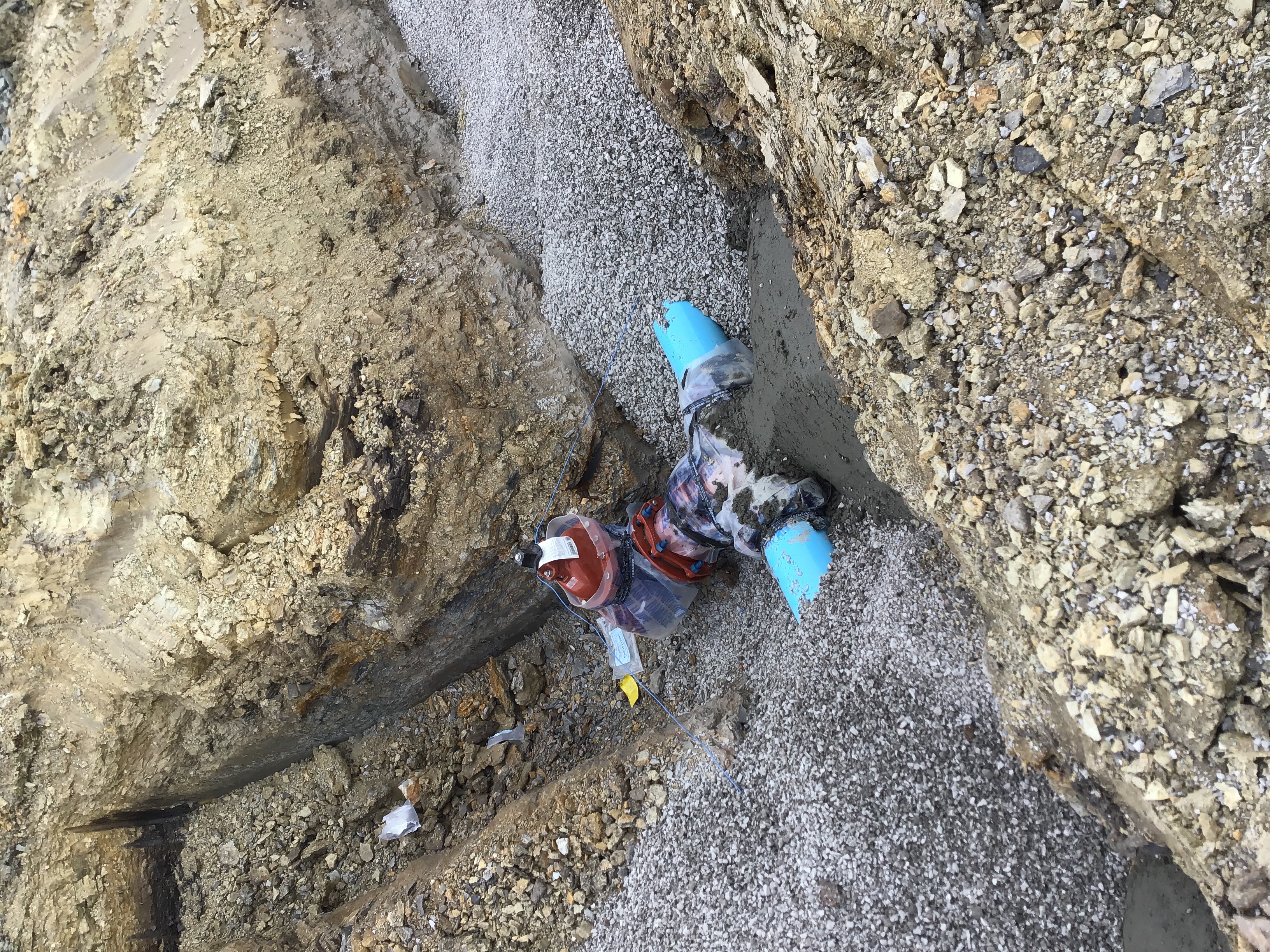

3-20-19 Gave Brad the GC the plans for the revised water.
Water Line - Construction Inspection Partial 03/20/2019
Misc
Informational
03/20/2019

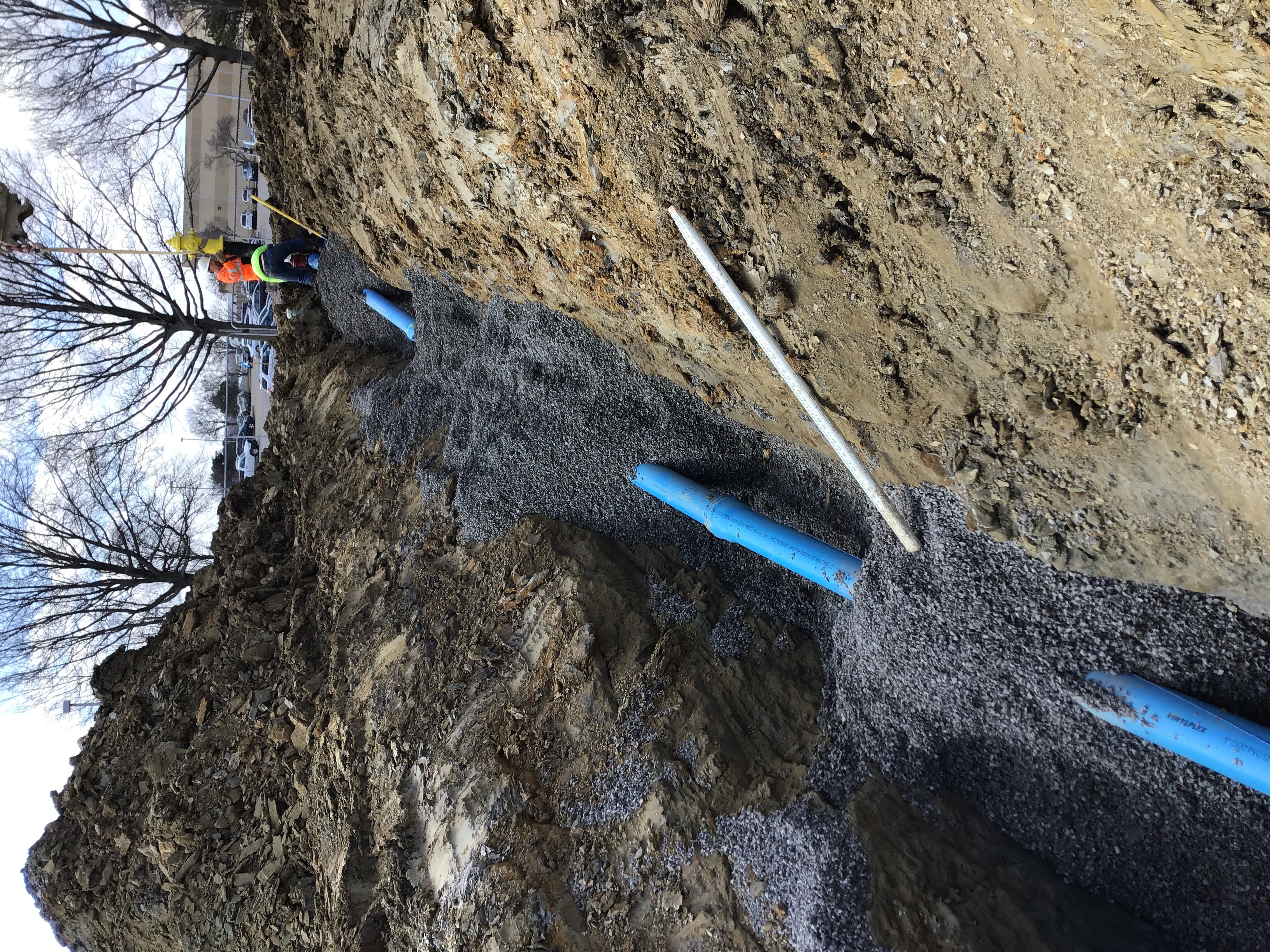

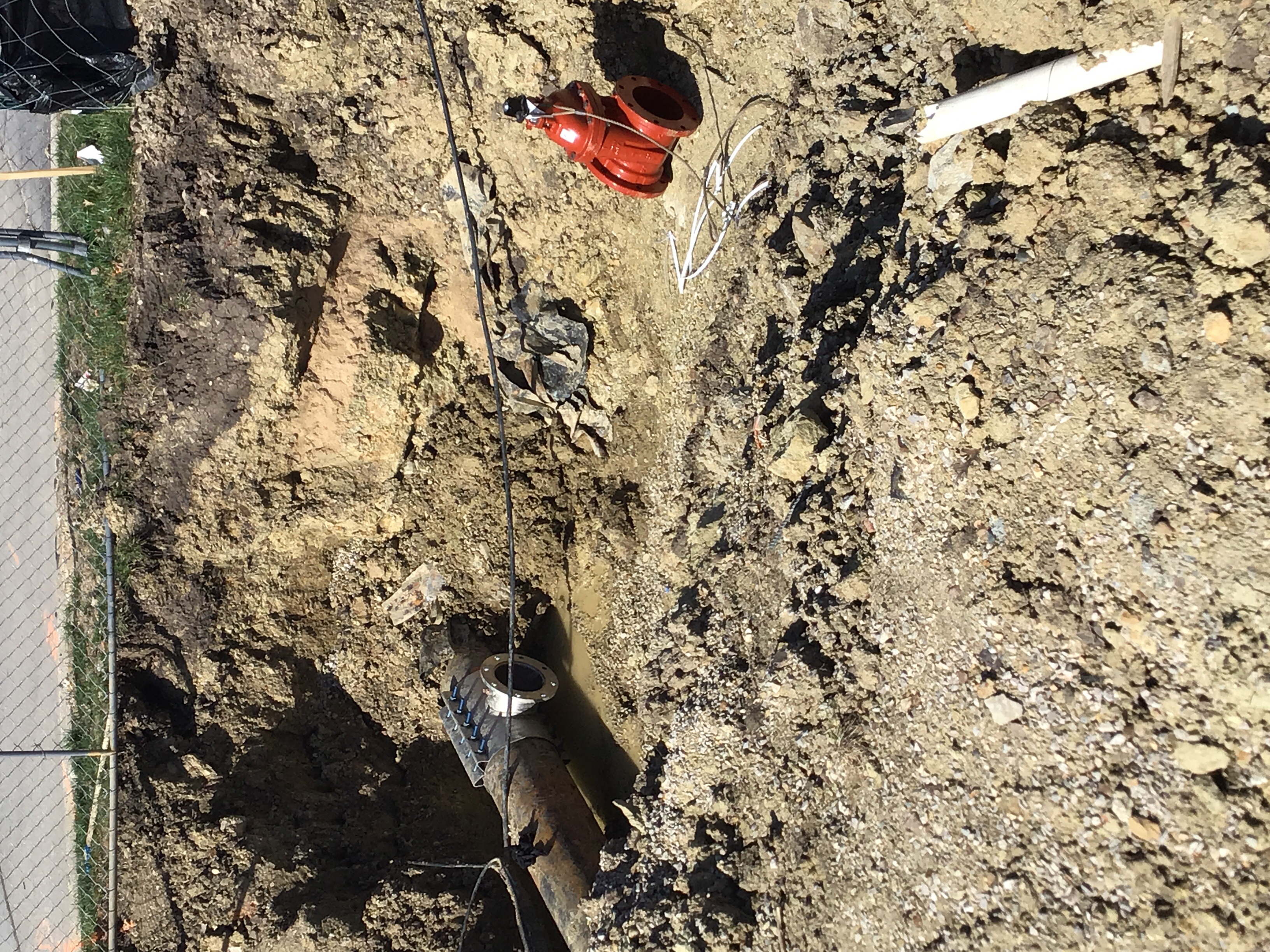

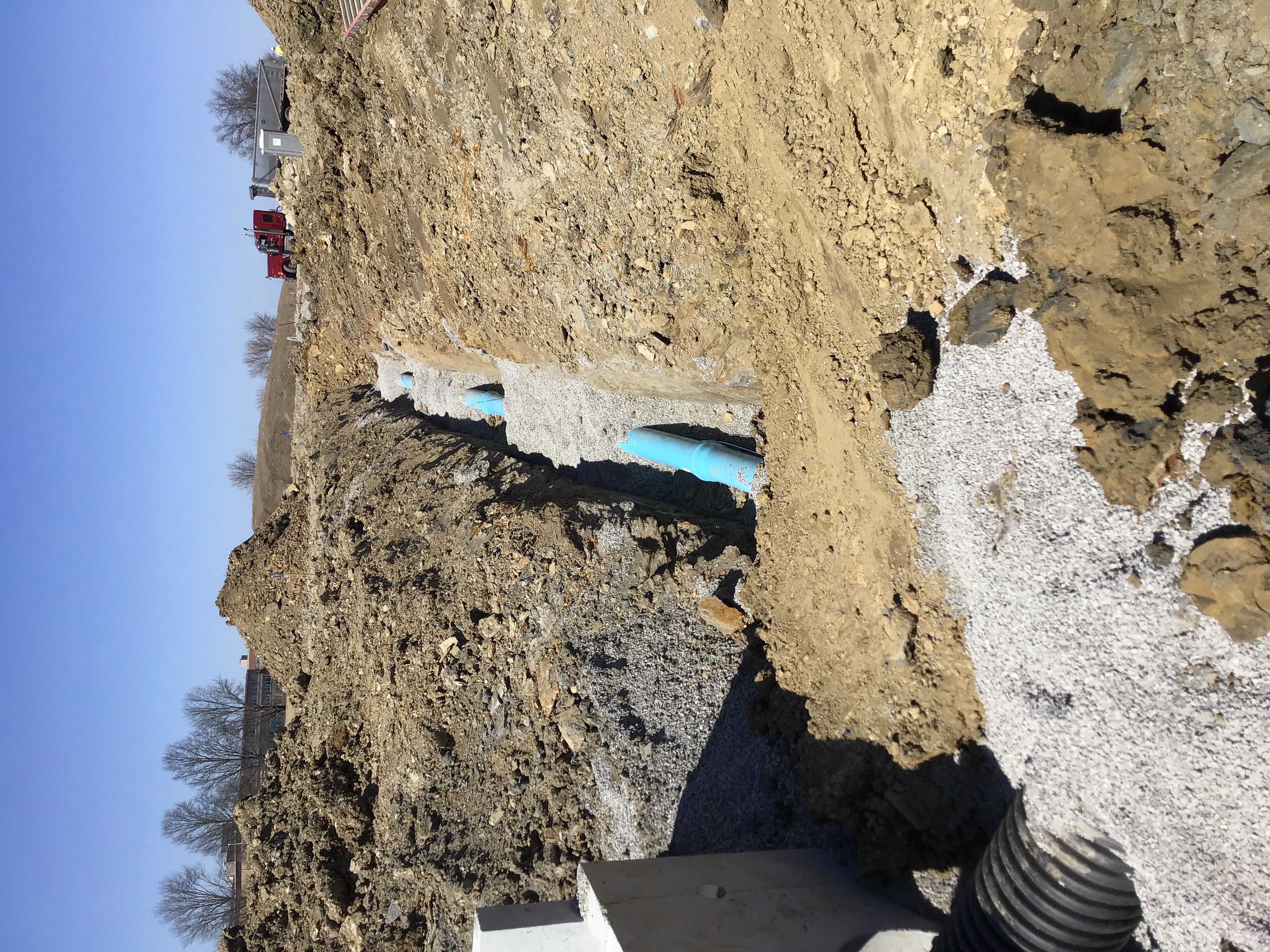

Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Water Line - Construction Inspection Partial 03/21/2019
Misc
Informational
03/20/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/21/2019

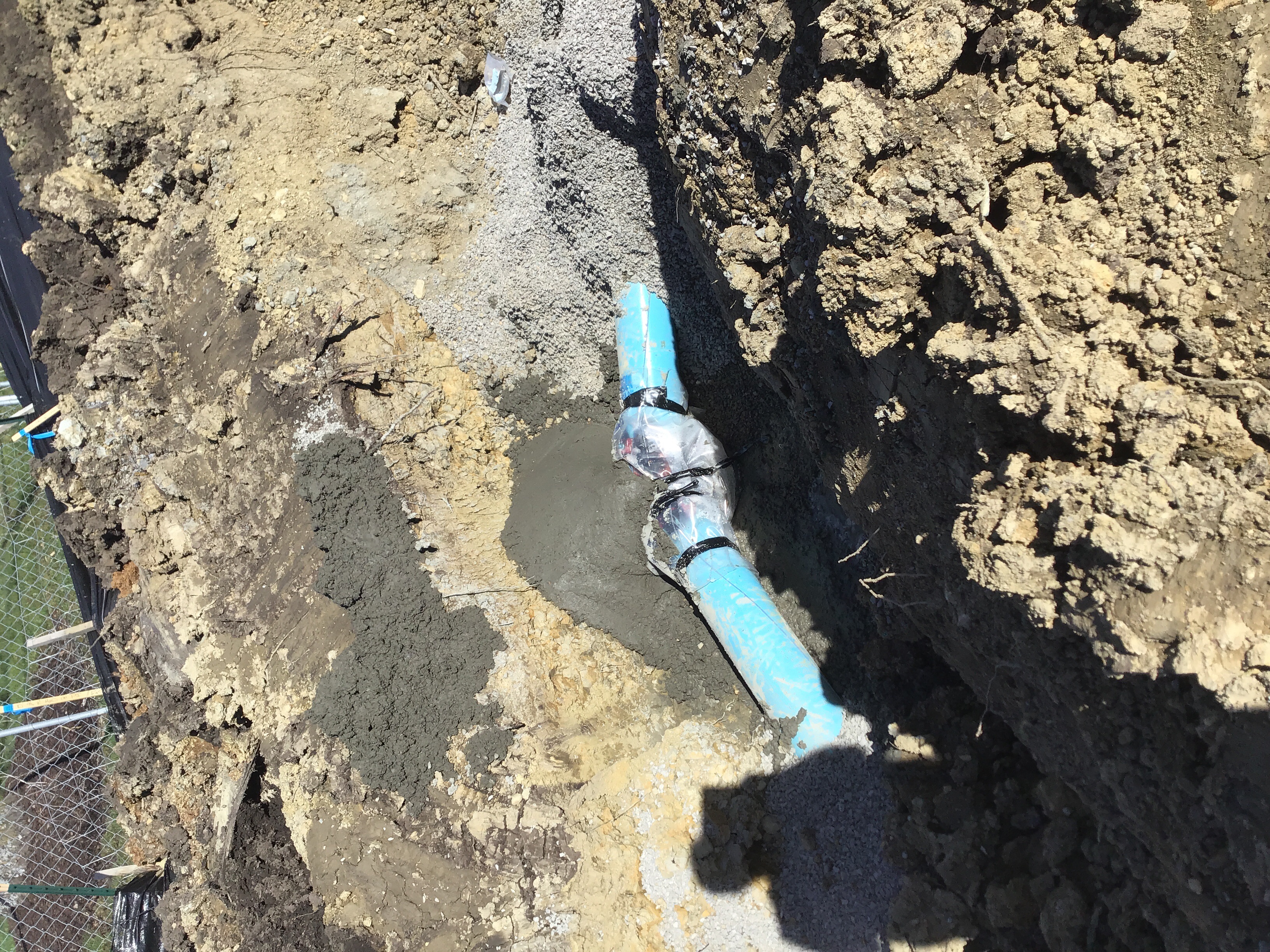

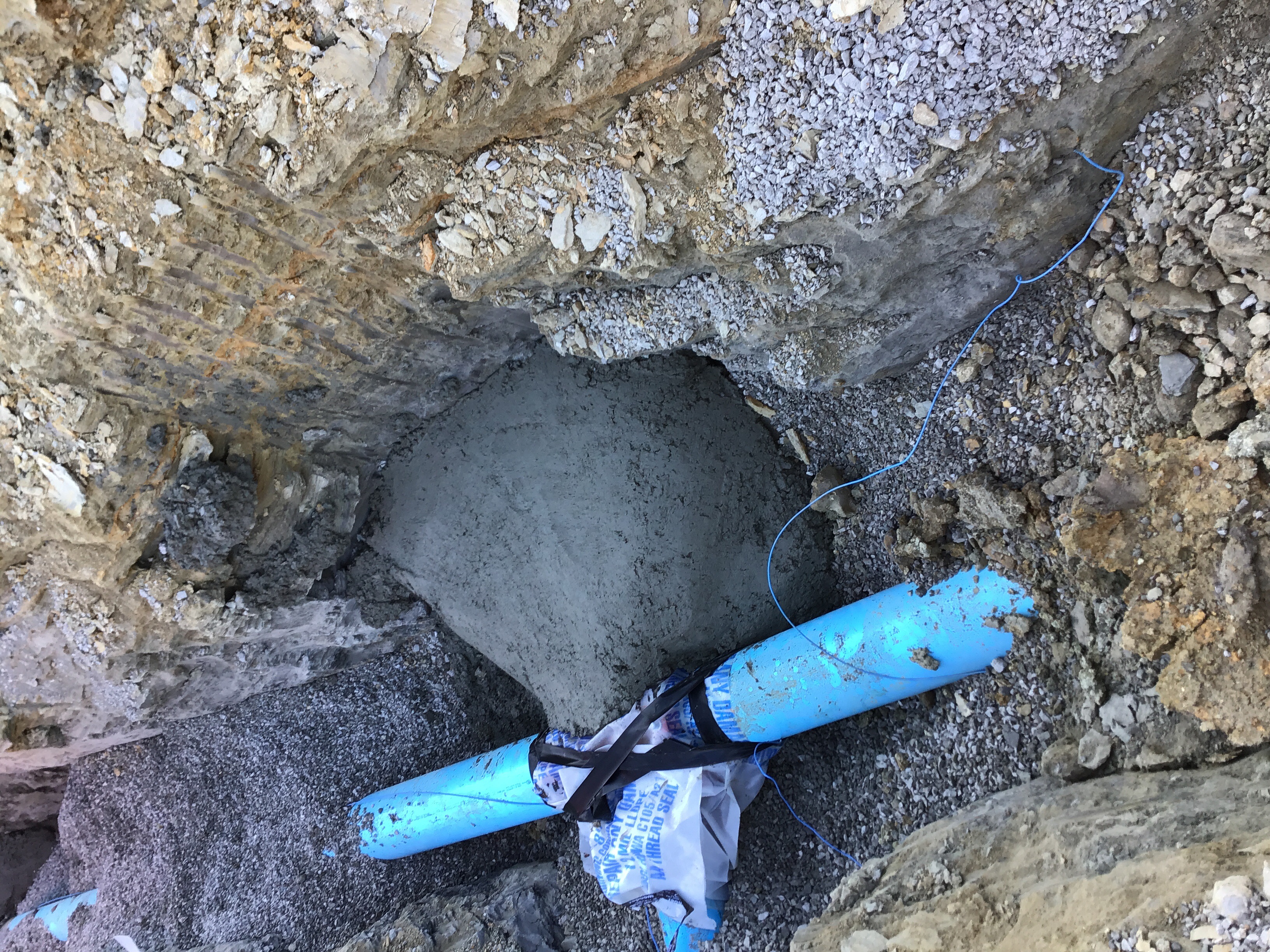

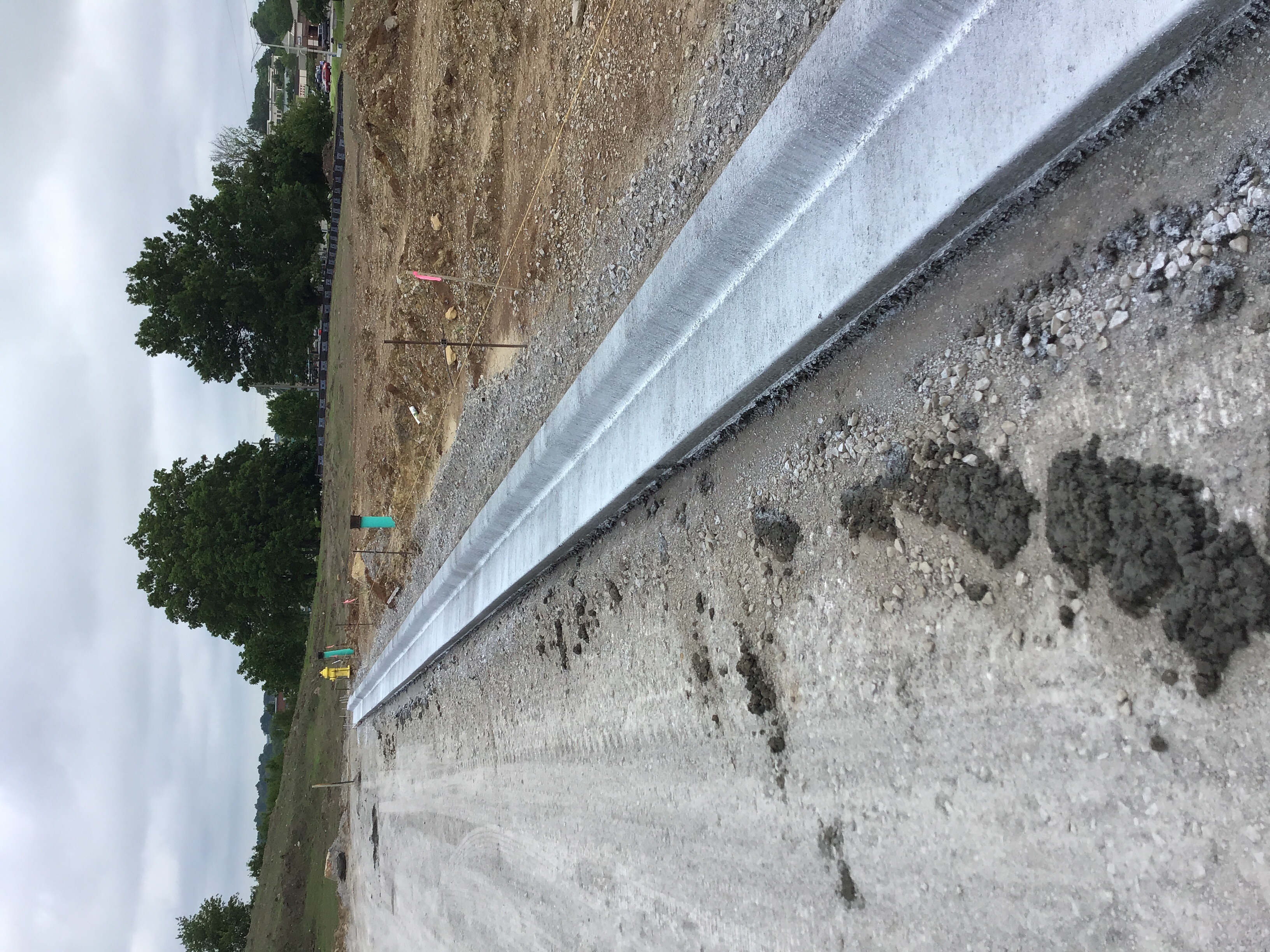

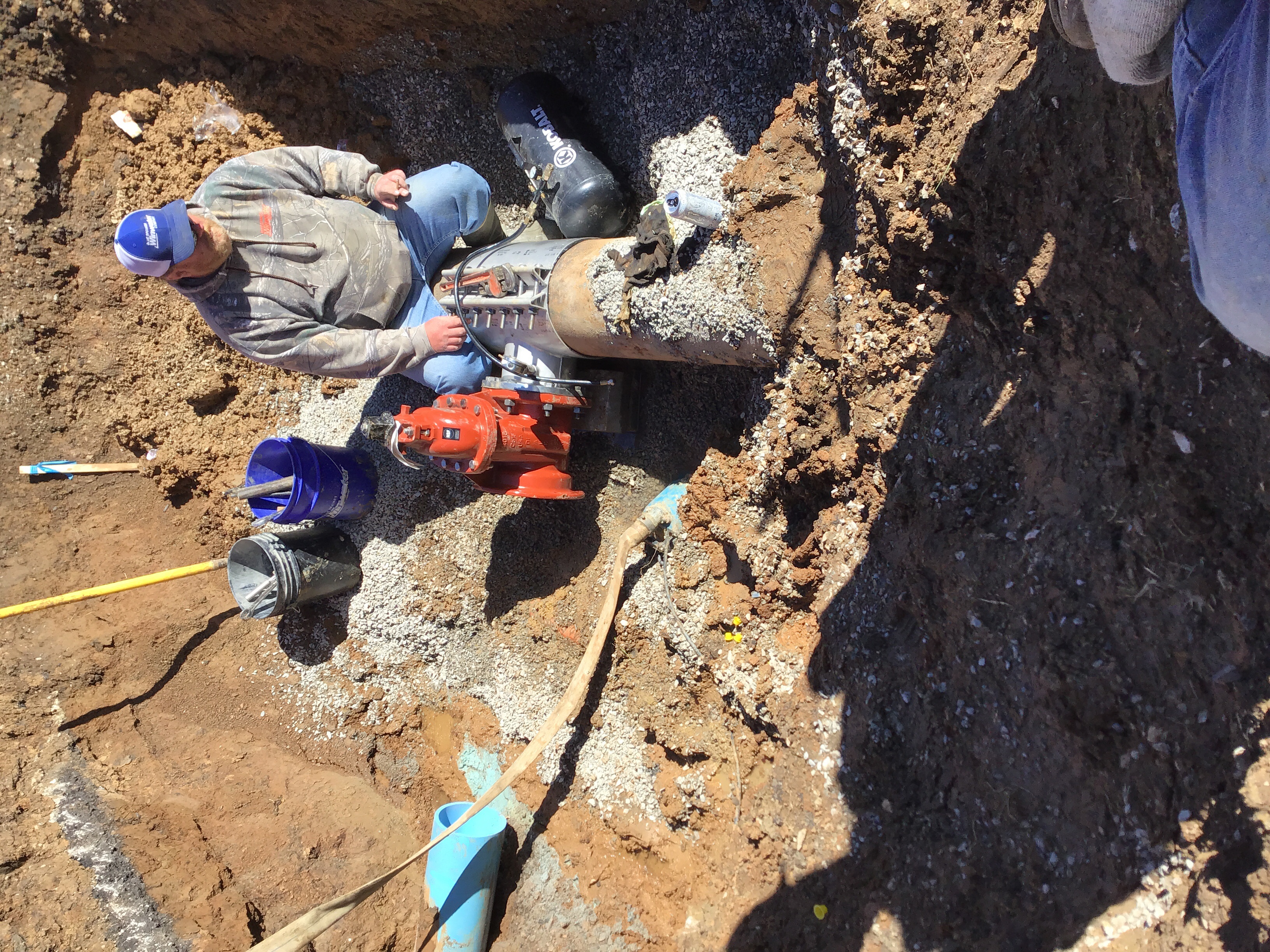

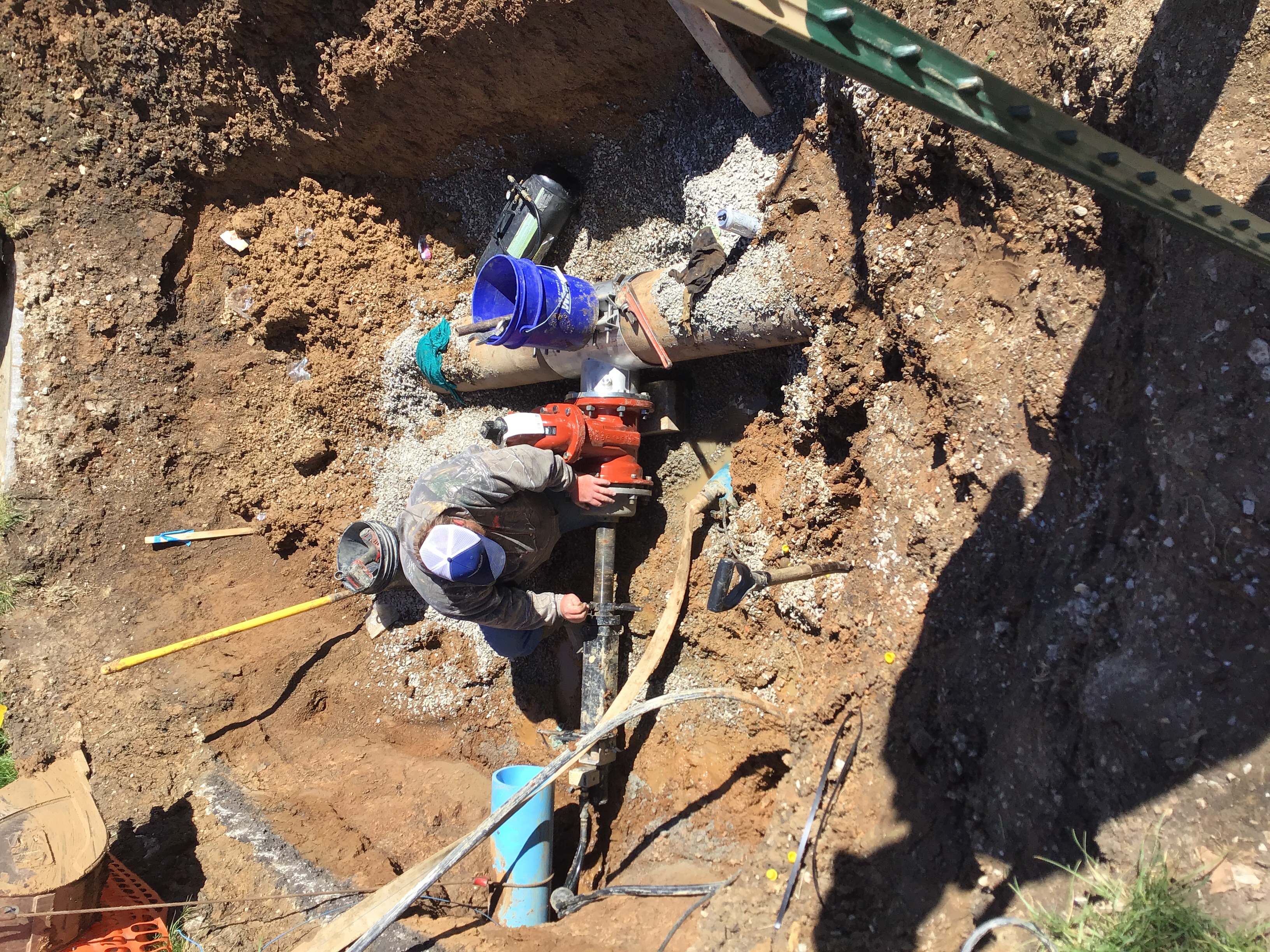

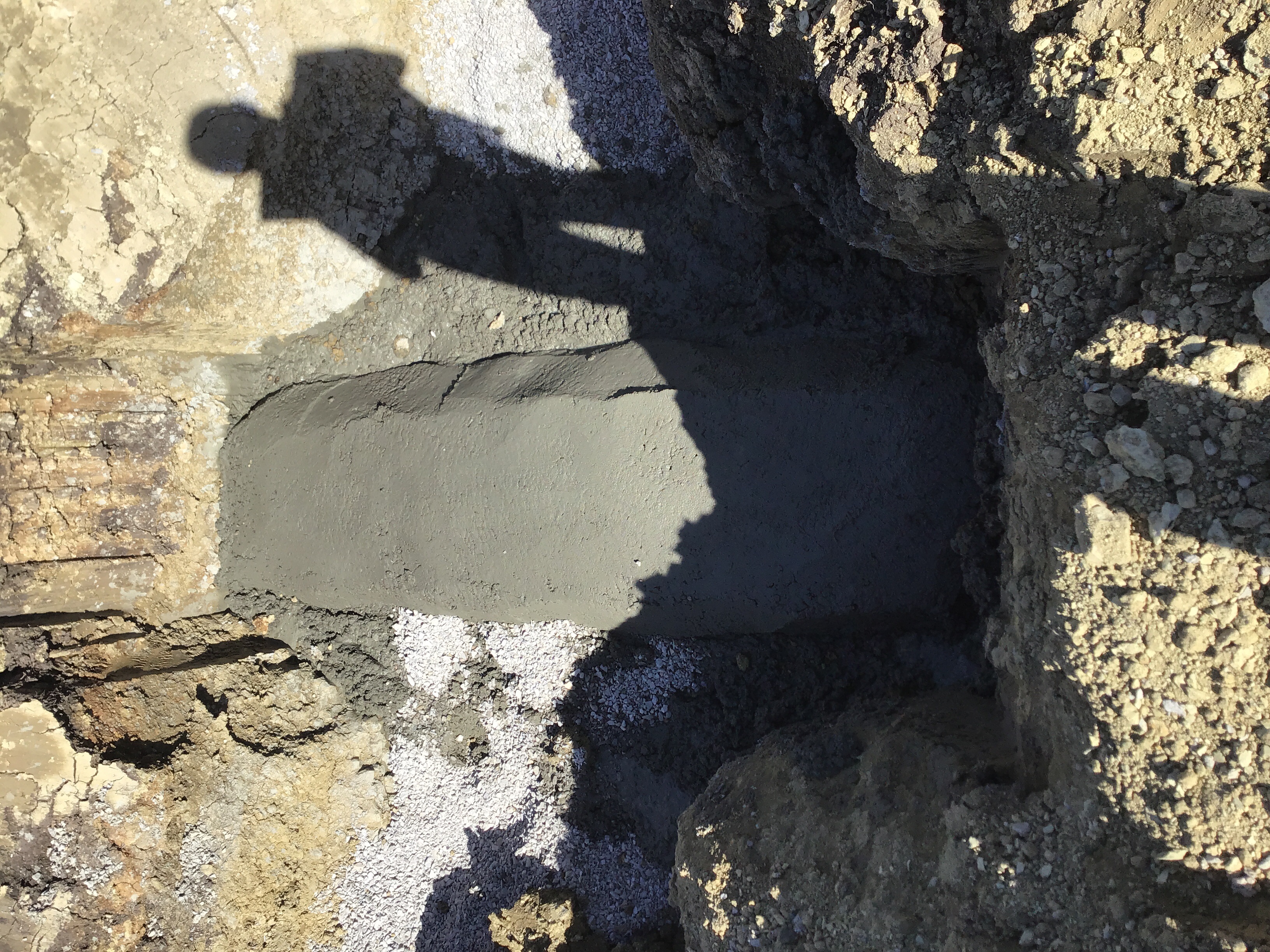

3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Water Line - Construction Inspection Partial 03/21/2019
Misc
Informational
03/21/2019

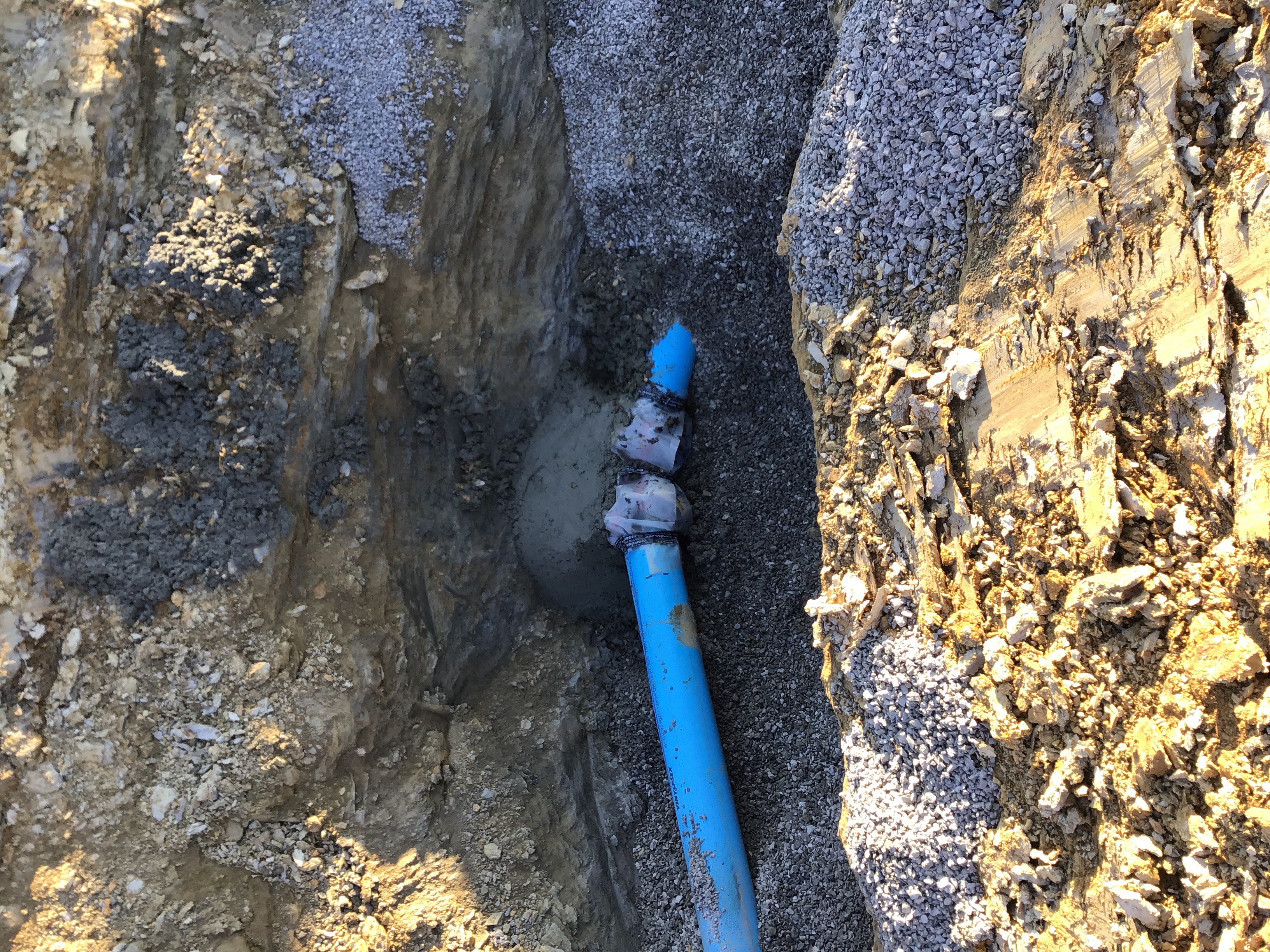

Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/21/2019

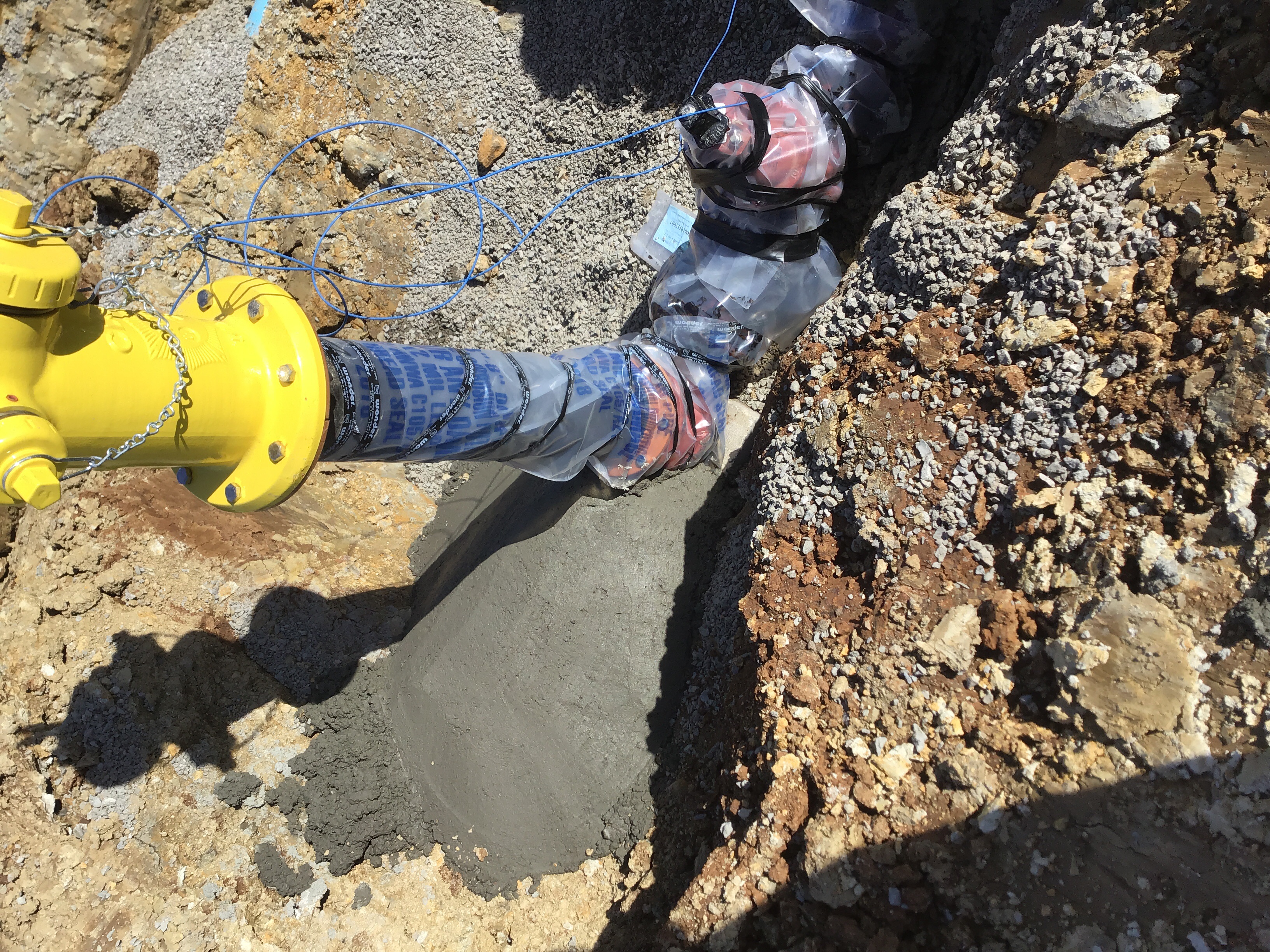

3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/21/2019
3-21-19 The crew laid 84ft of water line.
Storm Sewer Construction Inspection Partial 3/18/2019 03/21/2019
Misc
Informational
03/07/2019

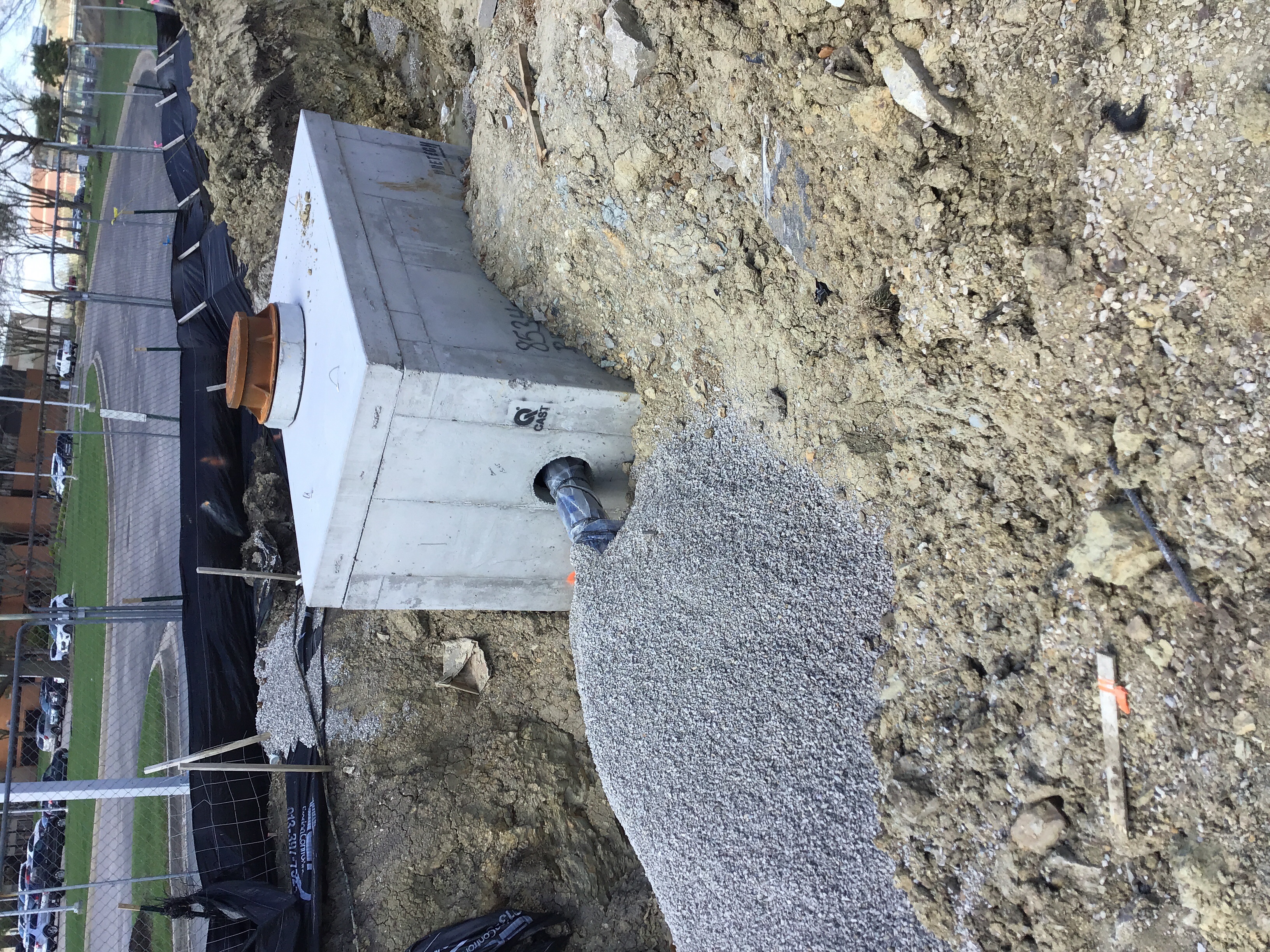

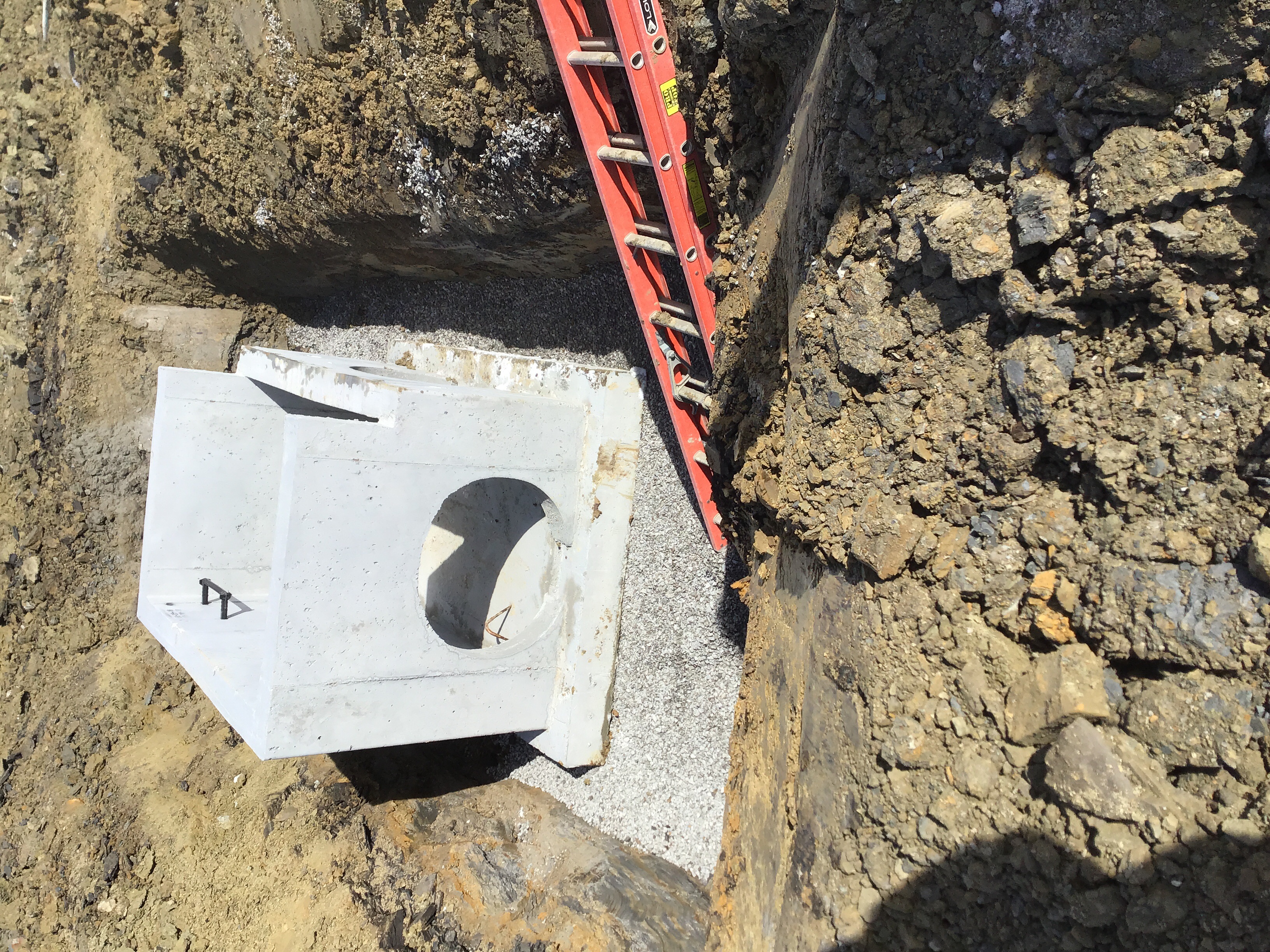

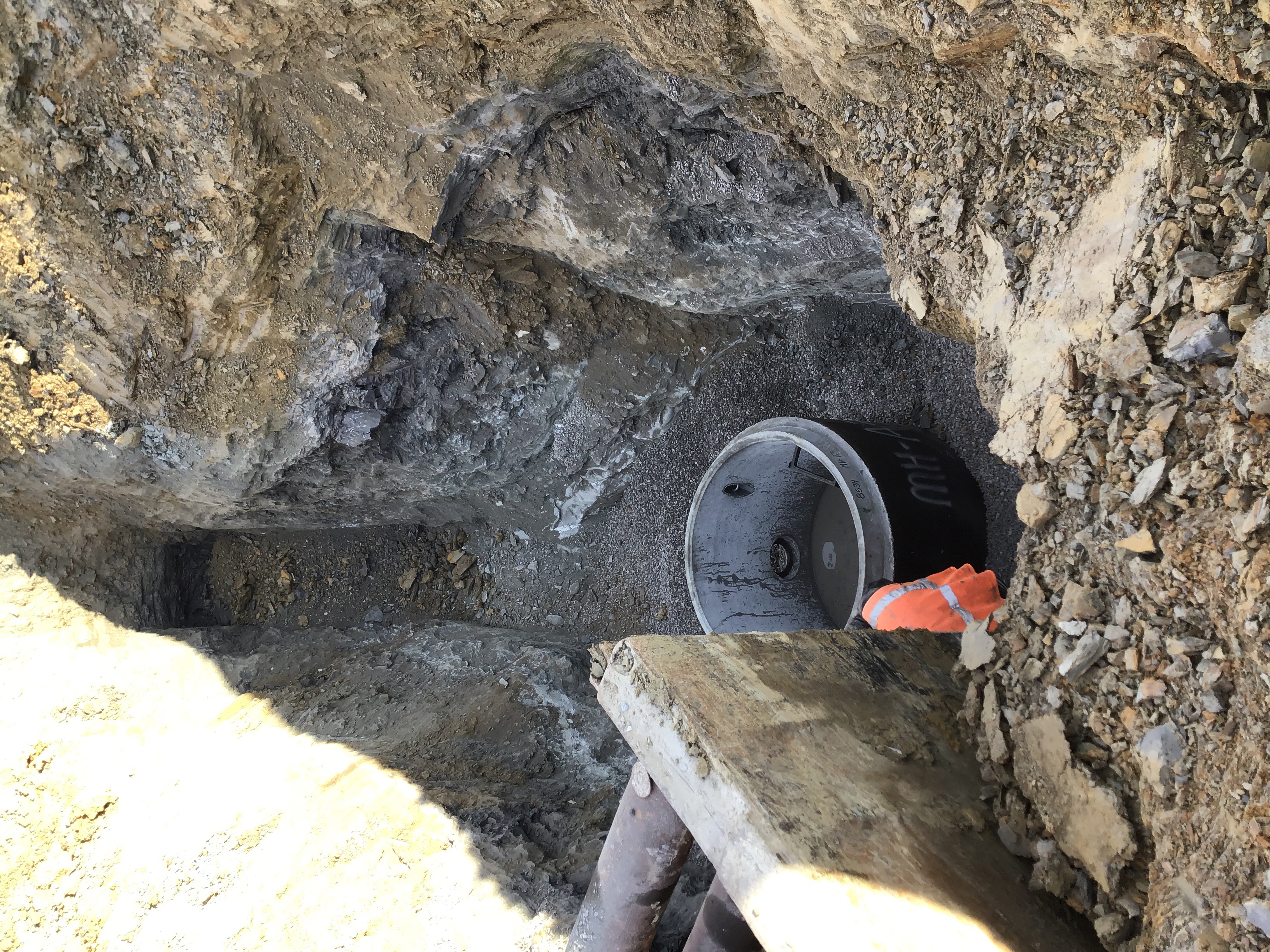

2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
03/07/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/07/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Misc
Informational
03/07/2019
2-6-19 10:10am to 10:45am. The crew has set curb inlet 201-202, 202-203. They have installed storm pipe from 201-202. I returned in the after noon, they set curb inlet 204-205. They installed storm pipe from 203-204 and installed rock and back filled.
Misc
Informational
03/07/2019

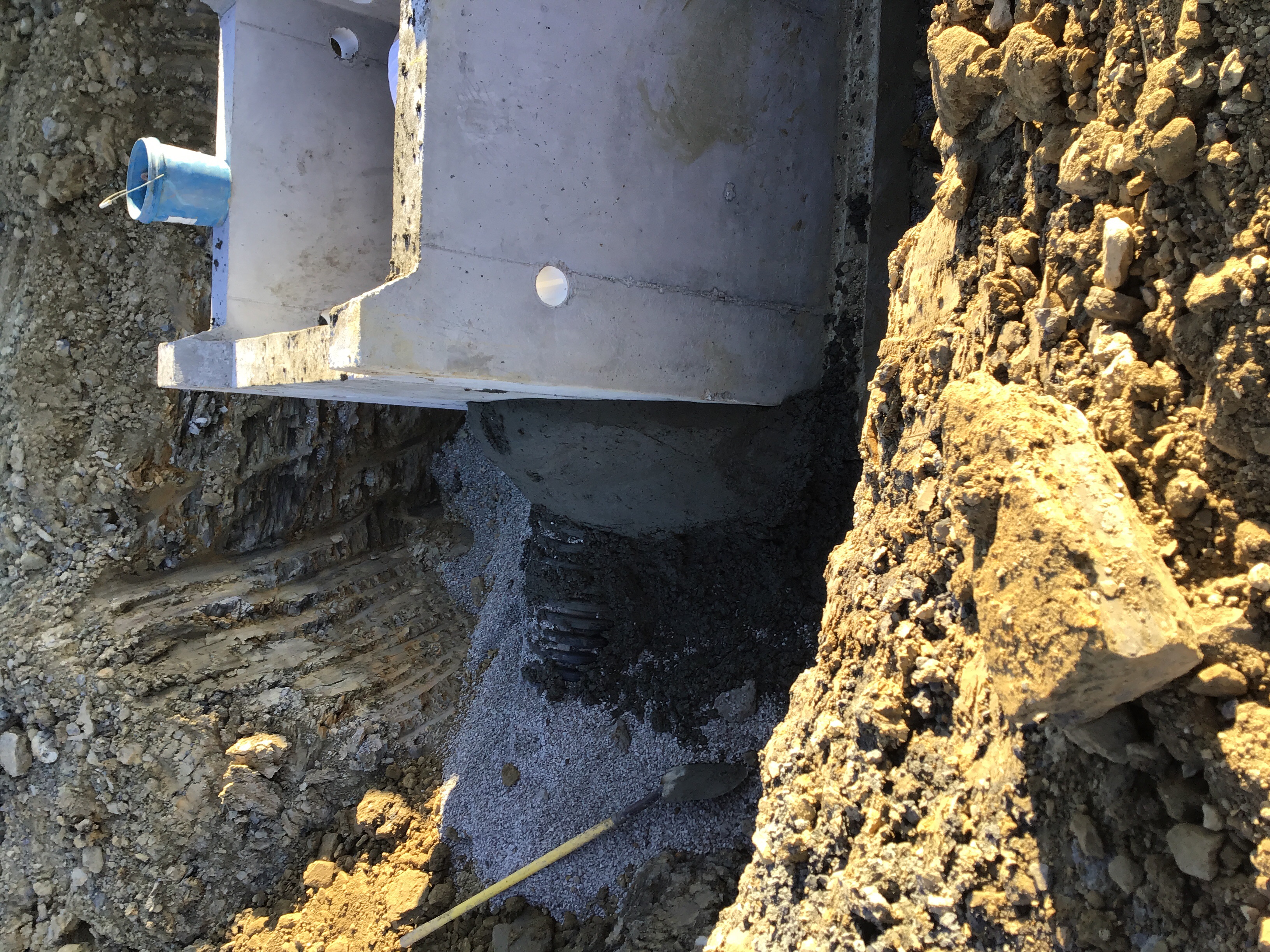

3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/07/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/21/2019

3-21-19 The crew placed box 201,202, and 301 and laid all storm pipe. They have covered with aggregate and will pour collars on 3-22-19.
Storm Sewer Construction Inspection Partial 3/22/2019 03/22/2019
Misc
Informational
03/21/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
03/21/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/21/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Misc
Informational
03/21/2019
2-6-19 10:10am to 10:45am. The crew has set curb inlet 201-202, 202-203. They have installed storm pipe from 201-202. I returned in the after noon, they set curb inlet 204-205. They installed storm pipe from 203-204 and installed rock and back filled.
Misc
Informational
03/21/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/21/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/21/2019
3-21-19 The crew placed box 201,202, and 301 and laid all storm pipe. They have covered with aggregate and will pour collars on 3-22-19.
Misc
Informational
03/22/2019

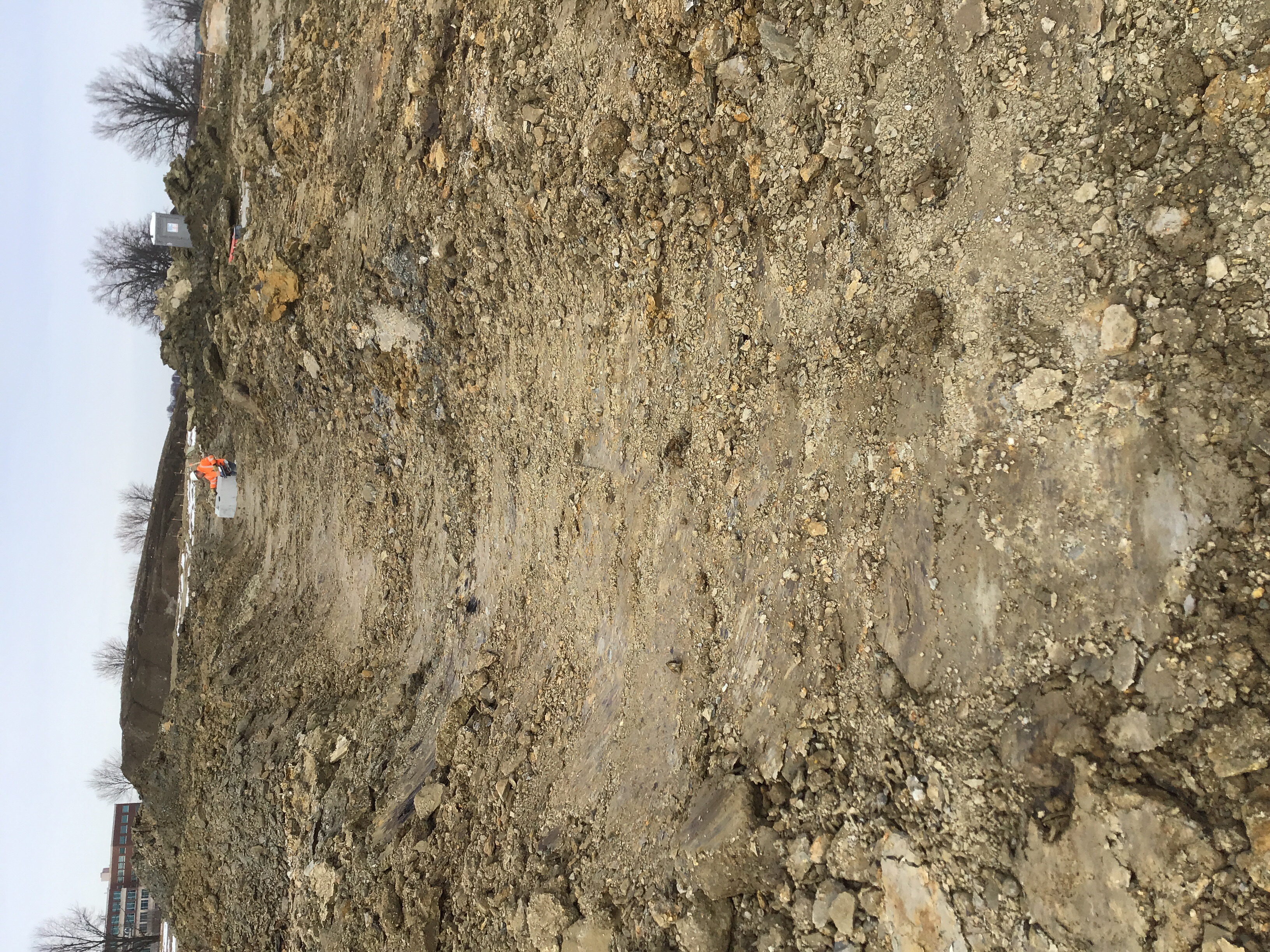

3-22-19 The Beemer crew are pouring collars and inverts.
Site Visit Partial 03/25/2019
Misc
Informational
03/20/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/20/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/20/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/20/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/20/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/20/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/20/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/20/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/20/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/20/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/20/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/20/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/20/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/20/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/20/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
03/20/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
03/20/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
03/20/2019

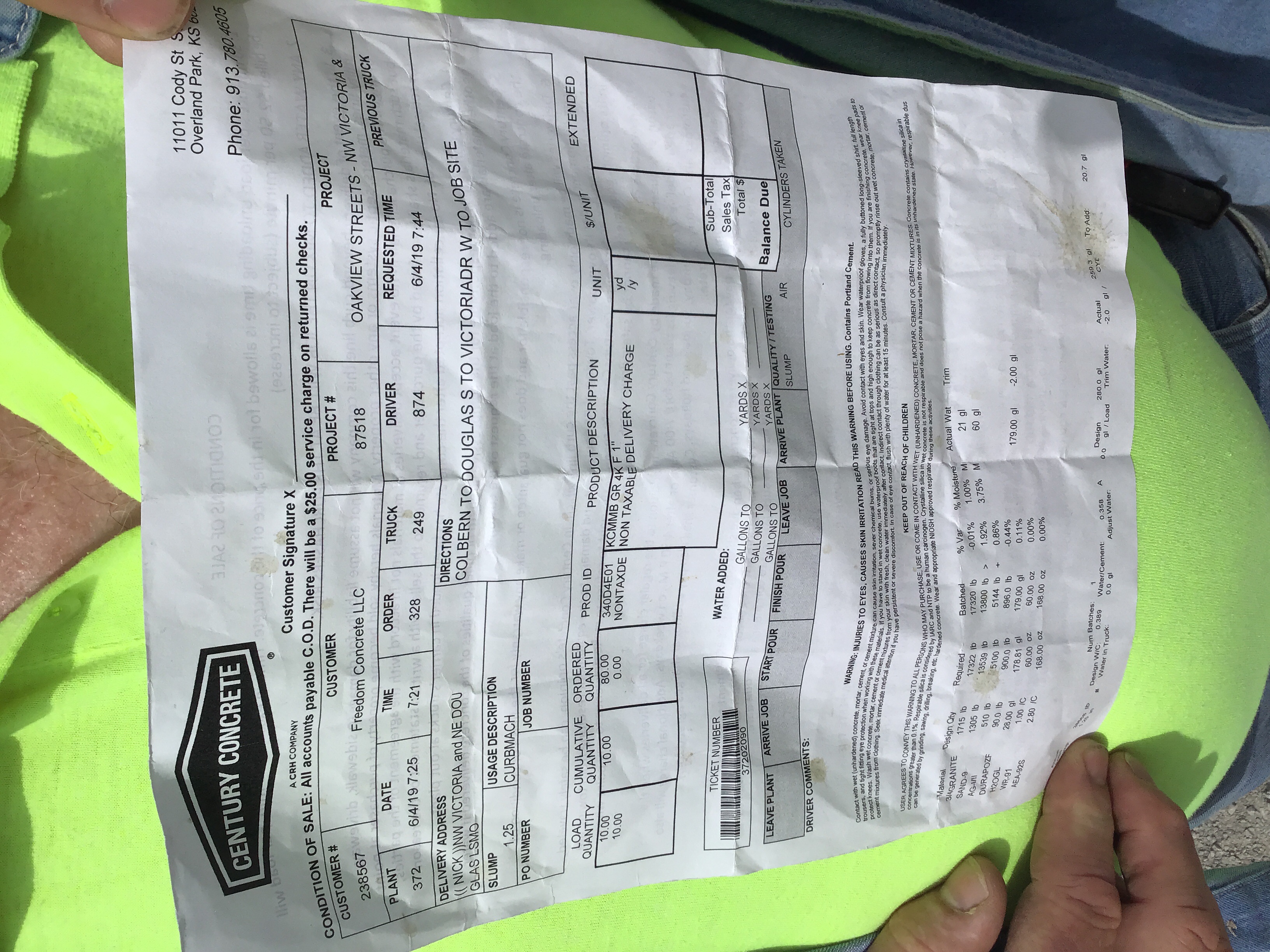

3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
03/25/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Water Line - Construction Inspection Partial 3/26/2019 03/26/2019
Misc
Informational
03/21/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/21/2019

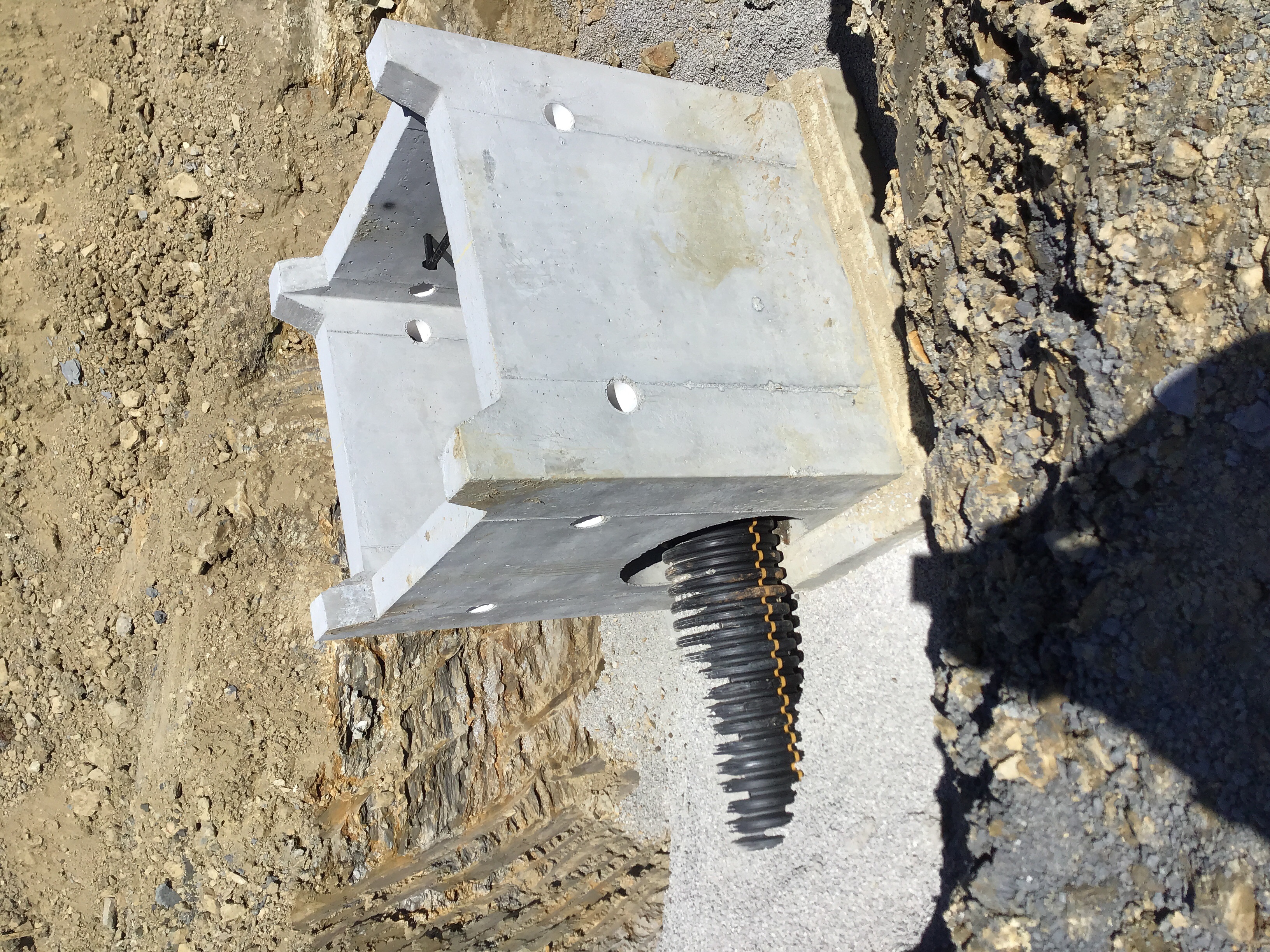

3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/21/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
03/26/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Water Line - Construction Inspection Partial 03/26/2019
Misc
Informational
03/26/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/26/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/26/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
03/26/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
03/26/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Water Line - Construction Inspection Partial 3/27/2019 03/27/2019
Misc
Informational
03/26/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/26/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/26/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
03/26/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
03/26/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
3-27-19 The crew placed approximately 80ft of water line.
Retaining Wall Inspection Partial 03/28/2019
Misc
Informational
03/28/2019

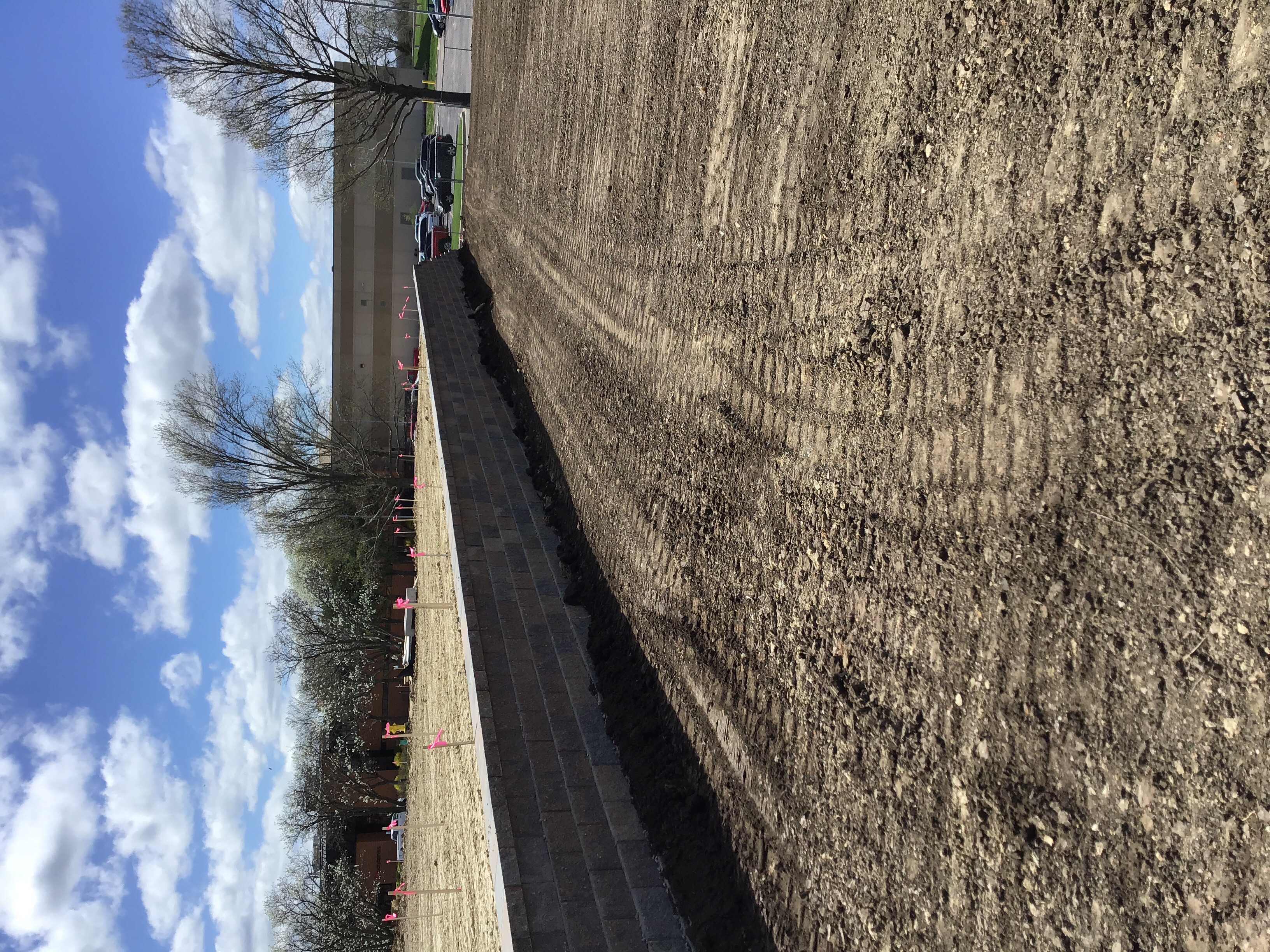

3-28-19 The crew have 5’ and 6’6” grid in place along with rock.
Water Line - Construction Inspection Partial 3/28/2019 03/28/2019
Misc
Informational
03/27/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/27/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/27/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
03/27/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
03/27/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/27/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
03/28/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
03/28/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Water Line - Construction Inspection Partial 04/01/2019
Misc
Informational
03/28/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
03/28/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
03/28/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
03/28/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
03/28/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
03/28/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/28/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/28/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
03/28/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
03/28/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
03/28/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/01/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Water Line - Construction Inspection Partial 04/03/2019
Misc
Informational
04/01/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/01/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/01/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/01/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/01/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/01/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/01/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/01/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/01/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/01/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/01/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/01/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/03/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Water Line - Construction Inspection Partial 04/09/2019
Misc
Informational
04/03/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/03/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/03/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/03/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/03/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/03/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/03/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/03/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/03/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/03/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/03/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/03/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/03/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Misc
Informational
04/09/2019
4-9-19 The Beemer crew have poured all trench checks and thrust blocks. They are going to wet tap tomorrow 4-10-19
Retaining Wall Inspection Partial 04/09/2019
Misc
Informational
03/28/2019
3-28-19 The crew have 5’ and 6’6” grid in place along with rock.
Misc
Corrective Action Required
04/09/2019
4-9-19 The crew have placed the finnal layer on the north side and are still working on the south west side of wall.
Sanitary Sewer Construction Inspection Partial 04/11/2019
Misc
Informational
02/13/2019
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
02/13/2019
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
02/13/2019
Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Misc
Corrective Action Required
02/13/2019
10:30 am Sanitary line has been placed from A-3 to approximately 100 feet past A-4 with service Lines to the east and west installed. Alpha Omega Geotech is on site and doing compaction tests during backfill. 2:40 pm sanitary line has been placed to A-5 with a service line on the east side. One more service line needs to be installed.
Misc
Corrective Action Required
02/13/2019
10:40 AM Beemer Construction finished laying sanitary service line and poured two inverts and three trench checks.
Misc
Informational
02/13/2019
2-13-19 The crew at Oak View dug up sanitary line at the north end of manhole A-4 and at A-2 to repair sags in the lines. They are back filled and waiting 30 days for testing.
Sanitary Sewer Construction Inspection Passed 4/11/2019 04/11/2019
Misc
Informational
04/11/2019
Joe Starlin 11/16/2018 3:29 PM The crew placed 130.17 LF sanitary pipe and back filled from A2 to A3. Then installed one 45 ft lateral run.
Misc
Informational
04/11/2019
Inspected the install of MH A-3 and 14 feet of pipe at 8:45am. Returned for inspection in the afternoon approximately 125 feet of sanitary pipe was installed.
Misc
Corrective Action Required
04/11/2019
Inspected 70 feet of sanitary main and 16 feet of lateral with trench check.
Misc
Corrective Action Required
04/11/2019
10:30 am Sanitary line has been placed from A-3 to approximately 100 feet past A-4 with service Lines to the east and west installed. Alpha Omega Geotech is on site and doing compaction tests during backfill. 2:40 pm sanitary line has been placed to A-5 with a service line on the east side. One more service line needs to be installed.
Misc
Corrective Action Required
04/11/2019
10:40 AM Beemer Construction finished laying sanitary service line and poured two inverts and three trench checks.
Misc
Informational
04/11/2019
2-13-19 The crew at Oak View dug up sanitary line at the north end of manhole A-4 and at A-2 to repair sags in the lines. They are back filled and waiting 30 days for testing.
Misc
Informational
04/11/2019
The sanitary line is complete and has passed all tests including camera .
Water Line - Construction Inspection Partial 4/11/2019 at 1:35 PM 04/11/2019
Misc
Informational
04/09/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/09/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/09/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/09/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/09/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/09/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/09/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/09/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/09/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/09/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/09/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/09/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/09/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Misc
Informational
04/09/2019
4-9-19 The Beemer crew have poured all trench checks and thrust blocks. They are going to wet tap tomorrow 4-10-19
Misc
Informational
04/11/2019
4-11-19 All water line is in and the wet tap on Victoria is done.
Retaining Wall Inspection Partial 4/11/2019 04/11/2019
Misc
Informational
04/09/2019
3-28-19 The crew have 5’ and 6’6” grid in place along with rock.
Misc
Corrective Action Required
04/09/2019
4-9-19 The crew have placed the finnal layer on the north side and are still working on the south west side of wall.
Misc
Informational
04/11/2019
4-11-19 The crew is done with the wall on the north side.
Retaining Wall Inspection Partial 04/16/2019
Misc
Informational
04/11/2019
3-28-19 The crew have 5’ and 6’6” grid in place along with rock.
Misc
Corrective Action Required
04/11/2019
4-9-19 The crew have placed the finnal layer on the north side and are still working on the south west side of wall.
Misc
Informational
04/11/2019
4-11-19 The crew is done with the wall on the north side.
Misc
Informational
04/16/2019
4-16-19 The crew are working on the west side of the wall, they are grouting around storm drain and will be continuing with the wall going south.
Water Line - Construction Inspection Partial 04/19/2019
Misc
Informational
04/11/2019

Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/11/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/11/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/11/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/11/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/11/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/11/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/11/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/11/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/11/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/11/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/11/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/11/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Misc
Informational
04/11/2019
4-9-19 The Beemer crew have poured all trench checks and thrust blocks. They are going to wet tap tomorrow 4-10-19
Misc
Informational
04/11/2019
4-11-19 All water line is in and the wet tap on Victoria is done.
Misc
Informational
04/19/2019
4-19-19 Winwater did the wet tap on Douglas and the Beemer crew will start tying in the water line.
Water Line - Hydrostatic Test Passed 4/22/2019 at 1:00 PM 04/22/2019
Misc
Informational
04/22/2019

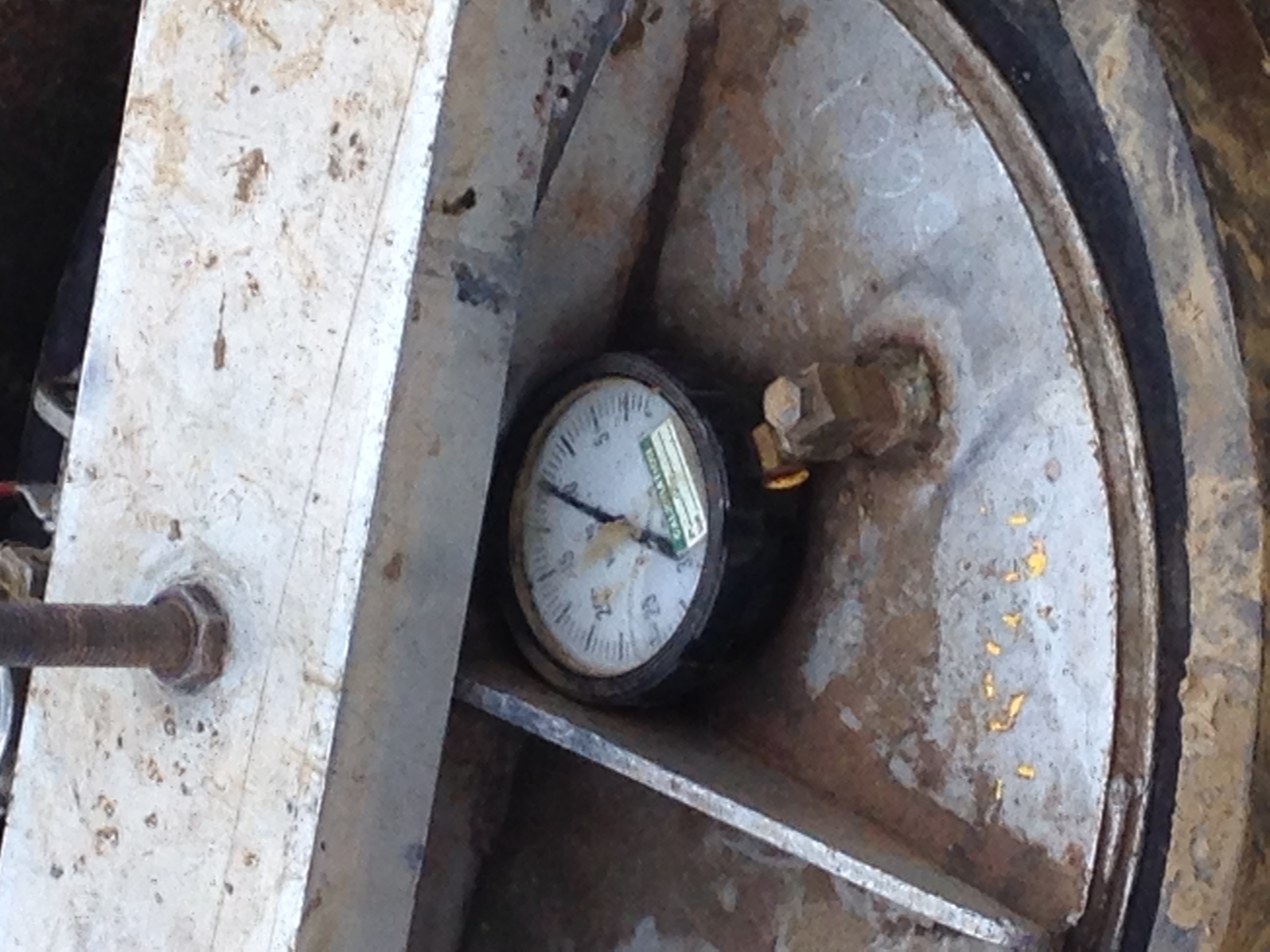

Joe Starlin 04/22/2019 3:50 PM The Beemer crew pressurized the water line at 200psi for two hours.
Site Visit Partial 3/26/2019 04/23/2019
Misc
Informational
03/25/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
03/25/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
03/25/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
03/25/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
03/25/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
03/25/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
03/25/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
03/25/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
03/25/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
03/25/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
03/25/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
03/25/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
03/25/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
03/25/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
03/25/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
03/25/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
03/25/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
03/25/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
03/25/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
04/23/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Pavement-Stabilized Subgrade Partial 04/24/2019
Misc
Informational
04/24/2019

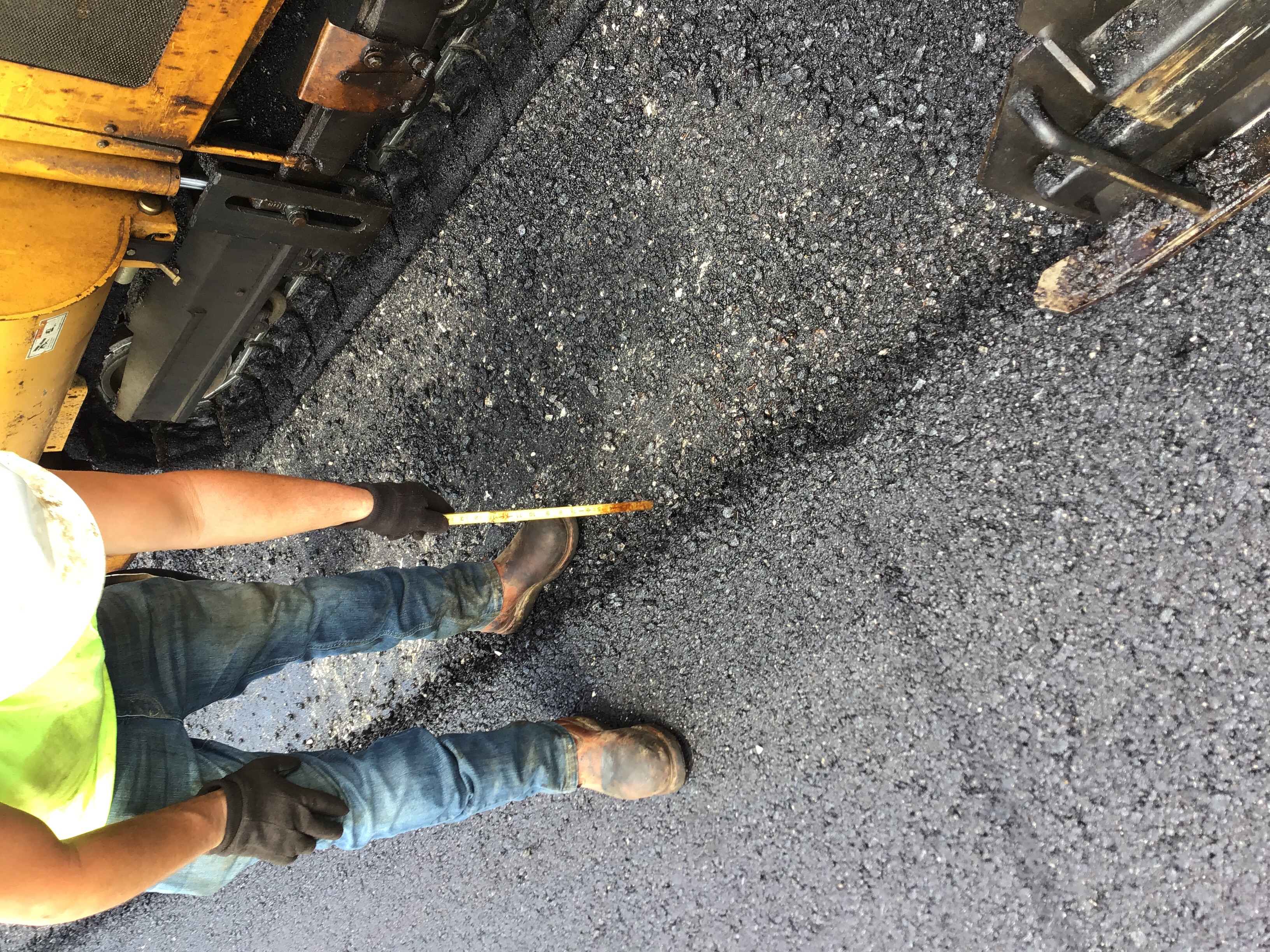

4-24-19 The Portland was mixed in all roadways.
Water Line - Construction Inspection Partial 04/24/2019
Misc
Informational
04/19/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/19/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/19/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/19/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/19/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/19/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/19/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/19/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/19/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/19/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/19/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/19/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/19/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Misc
Informational
04/19/2019
4-9-19 The Beemer crew have poured all trench checks and thrust blocks. They are going to wet tap tomorrow 4-10-19
Misc
Informational
04/19/2019
4-11-19 All water line is in and the wet tap on Victoria is done.
Misc
Informational
04/19/2019
4-19-19 Winwater did the wet tap on Douglas and the Beemer crew will start tying in the water line.
Misc
Informational
04/24/2019
4-24-19 The Beemer crew dechlorinated the entire water line. We will be pulling samples 4-25-19.
Water Line - Coliform Test 1 Partial 04/25/2019
Misc
Informational
04/25/2019
4-25-19 Beemer pulled four samples at four different locations. We will be waiting on lab results.
Site Visit Partial 05/01/2019
Misc
Informational
04/23/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
04/23/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
04/23/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
04/23/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
04/23/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
04/23/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
04/23/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
04/23/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
04/23/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
04/23/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
04/23/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
04/23/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
04/23/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
04/23/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
04/23/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
04/23/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
04/23/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
04/23/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
04/23/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
04/23/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
05/01/2019
5-1-19 No one on site due to weather.
Water Line - Coliform Test 1 Passed 05/13/2019
Misc
Informational
04/25/2019
4-25-19 Beemer pulled four samples at four different locations. We will be waiting on lab results.
Misc
Informational
05/13/2019
The first set of water samples have passed.
Corrective Action Required
05/13/2019
Water Line - Coliform Test 2 Passed 05/13/2019
Misc
Informational
04/26/2019
5-26-19 Took water samples at four locations on site and drove them to the lab.
Misc
Informational
05/13/2019
The second set of water samples pulled on 4-26-19 have passed.
Pavement-Stabilized Subgrade Passed 05/16/2019
Misc
Informational
04/24/2019
4-24-19 The Portland was mixed in all roadways.
Misc
Informational
05/16/2019
5-15-19 9am proof roll. The sub grade passed with corrections to a few areas. Third party inspector from Contech was on site and determined what was needed as far as corrections.
Pavement-Aggregate Base Partial 5/16/2019 05/16/2019
Misc
Informational
05/16/2019
5-16-19 They are laying base rock type 3 on all road surfaces and are planning for a proof roll the following week. 2:25pm All base rock has been laid.
Pavement-Aggregate Base Partial 05/16/2019
Misc
Informational
05/16/2019
5-16-19 They are laying base rock on all road surfaces and are planning for a proof roll the following week. 2:25pm All base rock has been laid.
Site Visit Partial 5/17/2019 05/17/2019
Misc
Informational
05/01/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
05/01/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
05/01/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
05/01/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
05/01/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
05/01/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
05/01/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
05/01/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
05/01/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
05/01/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
05/01/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
05/01/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
05/01/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
05/01/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
05/01/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
05/01/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
05/01/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
05/01/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
05/01/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
05/01/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
05/01/2019
5-1-19 No one on site due to weather.
Misc
Informational
05/17/2019

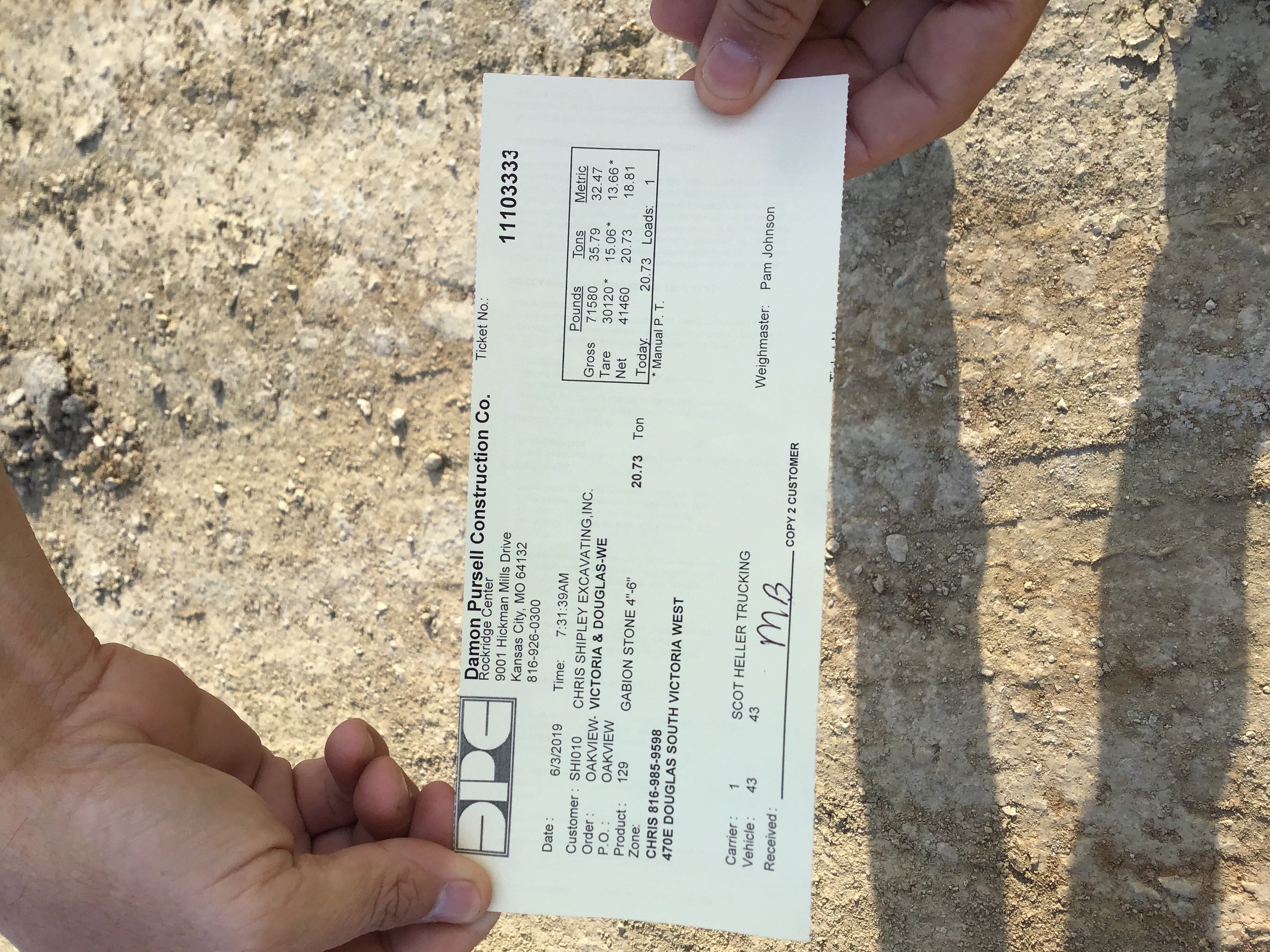

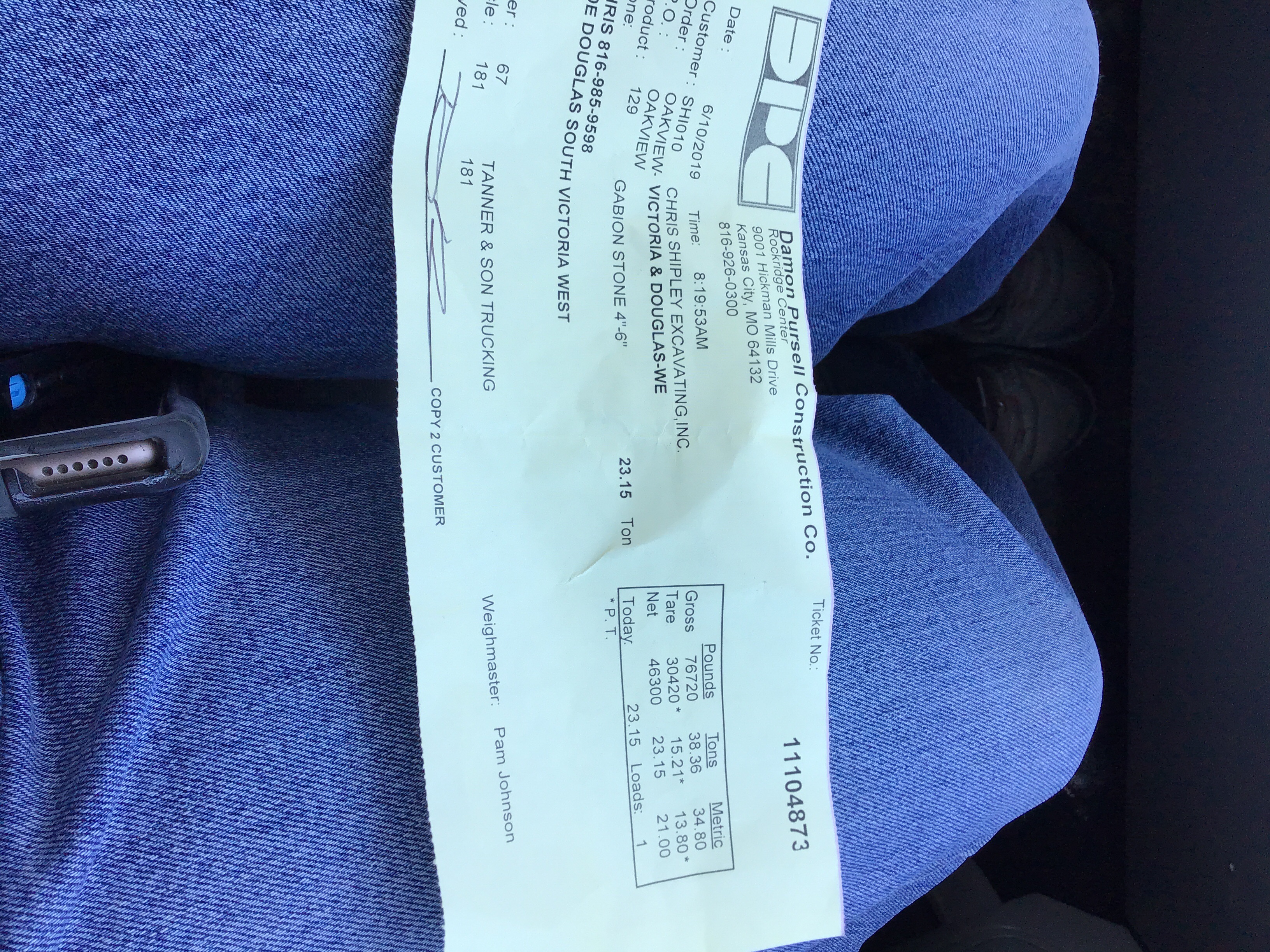

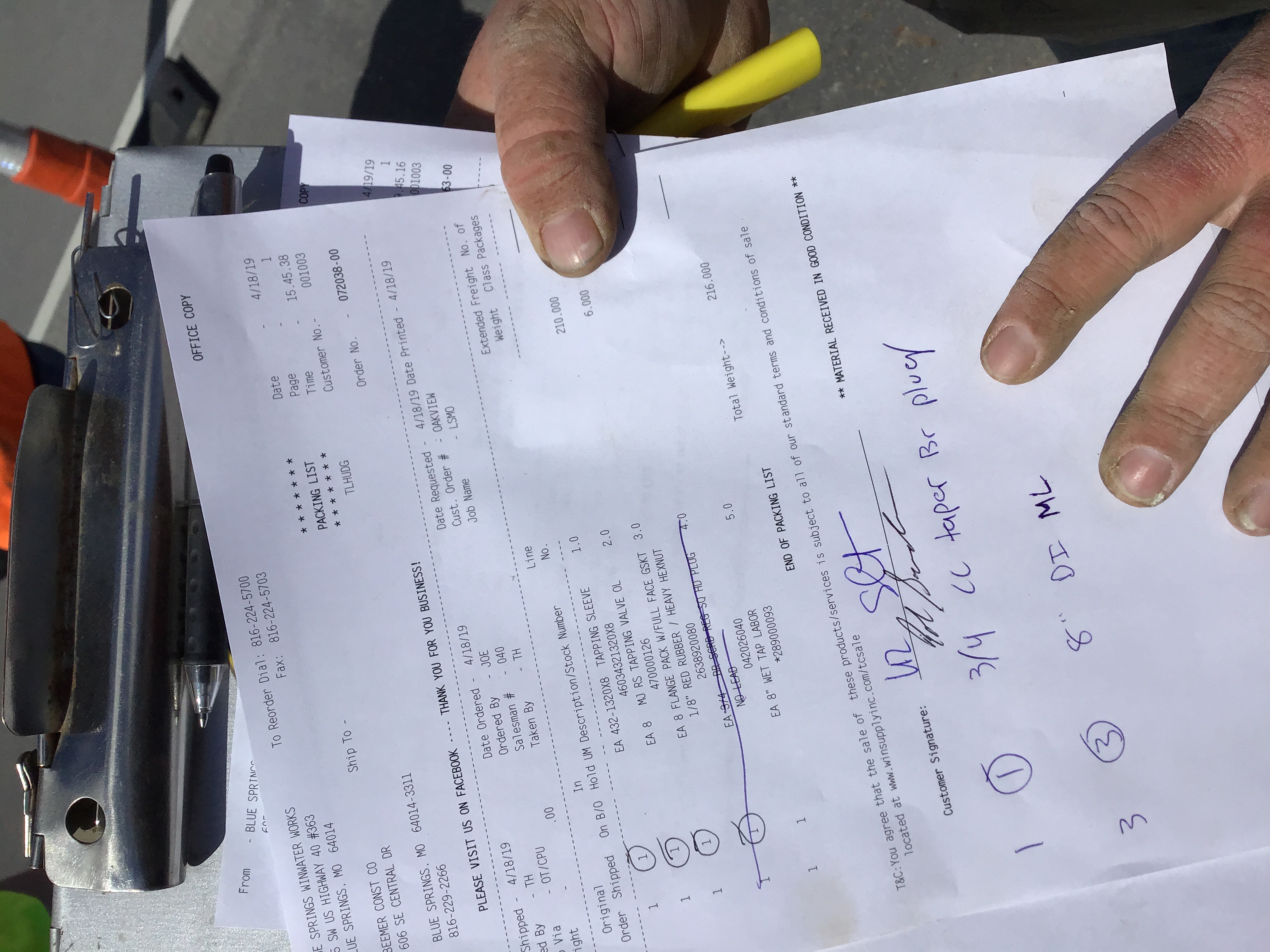

5-17-19 picked up base rock tickets from Shipley.
Water - Material Verification Passed 05/20/2019
Misc
Informational
03/20/2019
3-20-19 All water material on site appears to meet spec.
Site Visit Partial 05/21/2019
Misc
Informational
05/17/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
05/17/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
05/17/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
05/17/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
05/17/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
05/17/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
05/17/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
05/17/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
05/17/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
05/17/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
05/17/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
05/17/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
05/17/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
05/17/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
05/17/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
05/17/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
05/17/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
05/17/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
05/17/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
05/17/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
05/17/2019
5-1-19 No one on site due to weather.
Misc
Informational
05/17/2019
5-17-19 picked up base rock tickets from Shipley.
Misc
Informational
05/21/2019
5-21-19 At Oak View Storage water was rushing out of the NW corner of the site on to Douglas causing flooding. I spoke with Brad O’Connor the GC of the site and he said he would make calls and get erosion control in place to correct the problem.
Erosion Control Inspection Failed 05/22/2019
Misc
Informational
01/11/2019
All erosion control measures are in place properly.
Misc
Informational
05/22/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Site Visit Partial 05/30/2019
Misc
Informational
05/21/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
05/21/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
05/21/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
05/21/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
05/21/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
05/21/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
05/21/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
05/21/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
05/21/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
05/21/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
05/21/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
05/21/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
05/21/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
05/21/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
05/21/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
05/21/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
05/21/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
05/21/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
05/21/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
05/21/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
05/21/2019
5-1-19 No one on site due to weather.
Misc
Informational
05/21/2019
5-17-19 picked up base rock tickets from Shipley.
Misc
Informational
05/21/2019
5-21-19 At Oak View Storage water was rushing out of the NW corner of the site on to Douglas causing flooding. I spoke with Brad O’Connor the GC of the site and he said he would make calls and get erosion control in place to correct the problem.
Misc
Informational
05/30/2019
5-30-19 Steve Robbins and I walked the site observing base rock and erosion control. We determined that both need address due to weather.
Erosion Control Inspection Partial 5/31/2019 05/31/2019
Misc
Informational
05/22/2019
All erosion control measures are in place properly.
Misc
Informational
05/22/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
05/31/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Curb - Proof Roll Partial 06/03/2019
Misc
Informational
06/03/2019
6-3-19 The curb proof roll passed except for two areas that will need re-worked. There is approximately 40’ area on the SW side of the site and approximately 70’ on the E side that are being reworked.
Commercial Curb Inspection Partial 06/04/2019
Misc
Informational
06/04/2019
70 degrees cloudy. Freedom Concrete started pouring curb at 7:30am on the NE side. They did not start curing until 9:20am. I asked them why they were waiting, there reply was they wanted it to set up faster. I explained to them this is not are common practice and that they should be curing right away. They chose to ignore me. When they started curing I pointed out to the GC the cure was light, he said he was good with it because he will hold the concrete company accountable. At 11:30am none of the back side of the curb has been cured at this point. I spoke with the forman of the crew and he said he would cure the back side of the curb when all the curb is poured approximately 12:30pm. 1:15pm 81 degrees, starting to sprinkle. Curb is in except for some hand work. The back side of curb is cured but poorly.
Commercial Curb Inspection Partial 06/05/2019
Misc
Informational
06/04/2019
70 degrees cloudy. Freedom Concrete started pouring curb at 7:30am on the NE side. They did not start curing until 9:20am. I asked them why they were waiting, there reply was they wanted it to set up faster. I explained to them this is not are common practice and that they should be curing right away. They chose to ignore me. When they started curing I pointed out to the GC the cure was light, he said he was good with it because he will hold the concrete company accountable. At 11:30am none of the back side of the curb has been cured at this point. I spoke with the forman of the crew and he said he would cure the back side of the curb when all the curb is poured approximately 12:30pm. 1:15pm 81 degrees, starting to sprinkle. Curb is in except for some hand work. The back side of curb is cured but poorly.
Site Visit Partial 6/5/2019 06/05/2019
Misc
Informational
05/30/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
05/30/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
05/30/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
05/30/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
05/30/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
05/30/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
05/30/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
05/30/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
05/30/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
05/30/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
05/30/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
05/30/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
05/30/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
05/30/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
05/30/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
05/30/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
05/30/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
05/30/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
05/30/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
05/30/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
05/30/2019
5-1-19 No one on site due to weather.
Misc
Informational
05/30/2019
5-17-19 picked up base rock tickets from Shipley.
Misc
Informational
05/30/2019
5-21-19 At Oak View Storage water was rushing out of the NW corner of the site on to Douglas causing flooding. I spoke with Brad O’Connor the GC of the site and he said he would make calls and get erosion control in place to correct the problem.
Misc
Informational
05/30/2019
5-30-19 Steve Robbins and I walked the site observing base rock and erosion control. We determined that both need address due to weather.
Misc
Informational
06/05/2019
6-5-19 There is no activity on site 9:15am
Pavement-Proof Roll Partial 5/15/2019 06/10/2019
Misc
Informational
05/06/2019
We did a proof roll on the sub grade. There are four spots that will need skimmed off and more rock added random density checks will be taken. All other areas are good for base rock.
Misc
Informational
05/15/2019
5-15-19 Proof roll was done again for sub grade due to weather. There are some areas that will need addressed along the west side of the road that runs north and south. There is also a area at the west side of the road that runs eats and west that will need addressed. Corrections will be made by skimming sub grade and adding more rock.
Curb - Proof Roll Passed 6/10/2019 06/10/2019
Misc
Informational
06/03/2019
6-3-19 The curb proof roll passed except for two areas that will need re-worked. There is approximately 40’ area on the SW side of the site and approximately 70’ on the E side that are being reworked.
Misc
Informational
06/10/2019
6-10-19 The curb passed proof roll on the SW corner and the east side.
Site Visit Partial 6/12/2019 06/13/2019
Misc
Informational
06/05/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
06/05/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
06/05/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
06/05/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
06/05/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
06/05/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
06/05/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required
06/05/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
06/05/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
06/05/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
06/05/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
06/05/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
06/05/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
06/05/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
06/05/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
06/05/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
06/05/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
06/05/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
06/05/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
06/05/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
06/05/2019
5-1-19 No one on site due to weather.
Misc
Informational
06/05/2019
5-17-19 picked up base rock tickets from Shipley.
Misc
Informational
06/05/2019
5-21-19 At Oak View Storage water was rushing out of the NW corner of the site on to Douglas causing flooding. I spoke with Brad O’Connor the GC of the site and he said he would make calls and get erosion control in place to correct the problem.
Misc
Informational
06/05/2019
5-30-19 Steve Robbins and I walked the site observing base rock and erosion control. We determined that both need address due to weather.
Misc
Informational
06/05/2019
6-5-19 There is no activity on site 9:15am
Misc
Informational
06/13/2019
I spoke with Brad the GC about what testing is needed for asphalt. I told him we would need on site density and gradation testing along with all other standards we have.
Pavement-Proof Roll Passed 6/13/2019 06/13/2019
Misc
Informational
06/10/2019
We did a proof roll on the sub grade. There are four spots that will need skimmed off and more rock added random density checks will be taken. All other areas are good for base rock.
Misc
Informational
06/10/2019
5-15-19 Proof roll was done again for sub grade due to weather. There are some areas that will need addressed along the west side of the road that runs north and south. There is also a area at the west side of the road that runs eats and west that will need addressed. Corrections will be made by skimming sub grade and adding more rock.
Misc
Informational
06/13/2019
6-13-19 The proof roll passed on all roads. The turn lane on Douglas had one small soft spot that will need addressed and will be checked again tomorrow morning. There is no rain forecasted and they will be laying asphalt 6-14-19.
Pavement-Proof Roll Passed 6/15/2019 06/15/2019
Misc
Informational
06/15/2019
6-15-19 We proof rolled with 20 ton load and it passed with no problems.
Pavement-Surface Partial 6/15/2019 06/15/2019
Misc
Informational
06/15/2019
6-15-19 72 degrees cloudy. O’Donnell Way Construction are laying the asphalt base. The temperature out of the trucks has been around 270 degrees and out of the paver about the same. Geotech is doing the testing. Superior is also on site for testing. They finished base at 11:30am. I have collected all type 5 asphalt tickets.
Street - Wedge Lift Passed 06/20/2019
Misc
Informational
06/20/2019
6-20-19 11:45am They are placing the next lift over the 5” base lift. They started at the east entrance and completed that section. They are now on there second pass on the north and south road. Wedge lift is complete at the correct depth.
Street - Surface Course Partial 06/20/2019
Misc
Informational
06/20/2019
6-20-19 2:40pm They have laid the surface on the east entrance down to the north south intersection. They are using type 5. There is a delay due to truck shortage. O’Donnell Way Construction are laying the asphalt.Omega has been on site doing the testing.
Sidewalk Inspection Partial 06/27/2019
Misc
Informational
06/27/2019
6-27-19 3:30pm They have set up the sidewalk and are aware to stay in spec. They have poured almost all of the walk. The cure they laid down was inconsistent and light. I asked them to apply more cure.The tempature out side is 89 degrees with full sun. They pulled the forms without waiting so I asked them to cure the sides of the sidewalk as well They did so but with attitude.
Sidewalk Inspection Passed 7/22/2019 at 9:00 AM 07/22/2019
Misc
Informational
06/27/2019
6-27-19 3:30pm They have set up the sidewalk and are aware to stay in spec. They have poured almost all of the walk. The cure they laid down was inconsistent and light. I asked them to apply more cure.The tempature out side is 89 degrees with full sun. They pulled the forms without waiting so I asked them to cure the sides of the sidewalk as well They did so but with attitude.
Misc
Informational
07/22/2019
Joe Starlin 07/22/2019 1:03 PM The sidewalk appears to be in spec.
Water - Material Verification Passed 07/22/2019
Misc
Informational
03/20/2019
3-20-19 All water material on site appears to meet spec.
Sanitary - Material Verification Passed 07/22/2019
Storm - Material Verification Passed 07/22/2019
Water - Material Verification Passed 07/22/2019
Misc
Informational
03/20/2019
3-20-19 All water material on site appears to meet spec.
Storm Sewer Construction Inspection Passed 07/22/2019
Misc
Informational
03/22/2019
2-26-19 Beemer crew set junction box 101 and tied into the existing box on Victoria.
Misc
Informational
03/22/2019
2-28-19 The crew set box number 201 and dug trenches on 2-27-19. They are not working today 2-28-19.
Misc
Informational
03/22/2019
3-1-19 Beemer crew worked of box 201 then called it a day due to weather conditions.
Misc
Informational
03/22/2019
2-6-19 10:10am to 10:45am. The crew has set curb inlet 201-202, 202-203. They have installed storm pipe from 201-202. I returned in the after noon, they set curb inlet 204-205. They installed storm pipe from 203-204 and installed rock and back filled.
Misc
Informational
03/22/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/22/2019
3-7-19 The Beemer crew have installed box 205 along with the storm pipe. They are pouring inverts and collars and will cover with blankets due to temp.
Misc
Informational
03/22/2019
3-21-19 The crew placed box 201,202, and 301 and laid all storm pipe. They have covered with aggregate and will pour collars on 3-22-19.
Misc
Informational
03/22/2019
3-22-19 The Beemer crew are pouring collars and inverts.
Retaining Wall Inspection Passed 07/22/2019
Misc
Informational

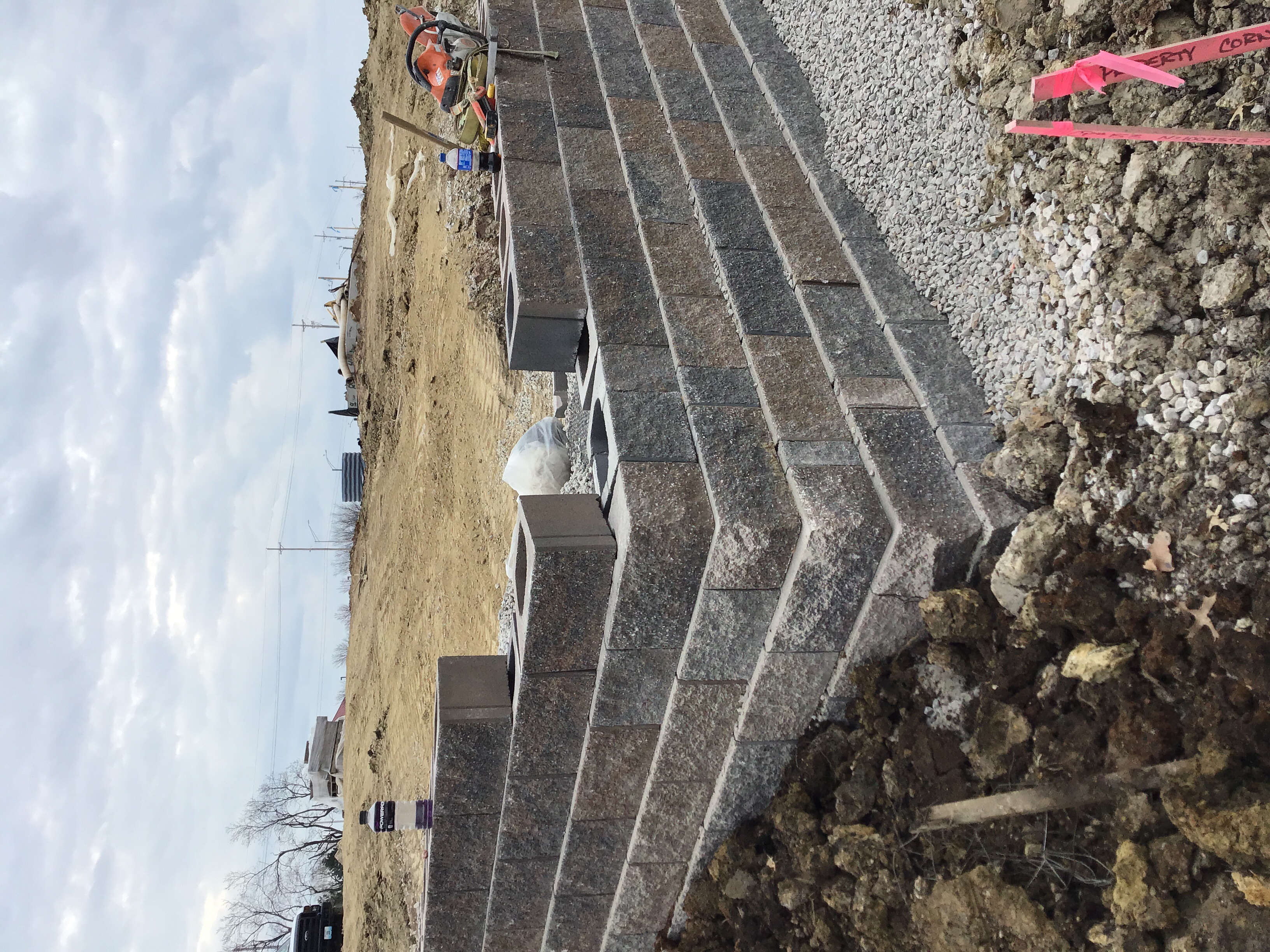

04/16/2019
3-28-19 The crew have 5’ and 6’6” grid in place along with rock.
Misc
Corrective Action Required
04/16/2019
4-9-19 The crew have placed the finnal layer on the north side and are still working on the south west side of wall.
Misc
Informational
04/16/2019
4-11-19 The crew is done with the wall on the north side.
Misc
Informational
04/16/2019
4-16-19 The crew are working on the west side of the wall, they are grouting around storm drain and will be continuing with the wall going south.
Water Line - Construction Inspection Passed 07/22/2019
Misc
Informational
04/24/2019
Approximately 130 ft of PC 235 pipe has been installed . The crew has also places tracer wire and adequate amount of gravel has been placed above and below pipe.
Misc
Informational
04/24/2019
3-21-19 The crew, upon arrival, poured concrete kickers and thrust blocks on all appropriate locations. The crew is continuing on water lines through out today.
Misc
Informational
04/24/2019
3-21-19 The crew laid 84ft of water line.
Misc
Corrective Action Required
04/24/2019
3-26-19 The Beemer crew are getting ready to have Magnum Boring start boarding to water line on Douglas.
Misc
Informational
04/24/2019
3-26-19 The crew have placed 100ft of water line and placed a hydrant.
Misc
Informational
04/24/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/24/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/24/2019
2-27-19 The Beemer crew have poured kickers and are starting to install more water line.
Misc
Informational
04/24/2019
3-27-19 The crew placed approximately 80ft of water line.
Misc
Informational
04/24/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/24/2019
3-28-19 The crew have placed both boxes for fire line, water line is all the way across Douglas Road. They are back filling before rain sets in.
Misc
Informational
04/24/2019
4-1-19 The crew did 110ft west side of 90. 80ft north of 90. Water line.
Misc
Informational
04/24/2019
4-3-19 The crew have placed 160ft of water line and also ran water line from the main to where the storage building will be.
Misc
Informational
04/24/2019
4-9-19 The Beemer crew have poured all trench checks and thrust blocks. They are going to wet tap tomorrow 4-10-19
Misc
Informational
04/24/2019
4-11-19 All water line is in and the wet tap on Victoria is done.
Misc
Informational
04/24/2019
4-19-19 Winwater did the wet tap on Douglas and the Beemer crew will start tying in the water line.
Misc
Informational
04/24/2019
4-24-19 The Beemer crew dechlorinated the entire water line. We will be pulling samples 4-25-19.
Pavement-Aggregate Base Passed 07/22/2019
Misc
Informational
05/16/2019

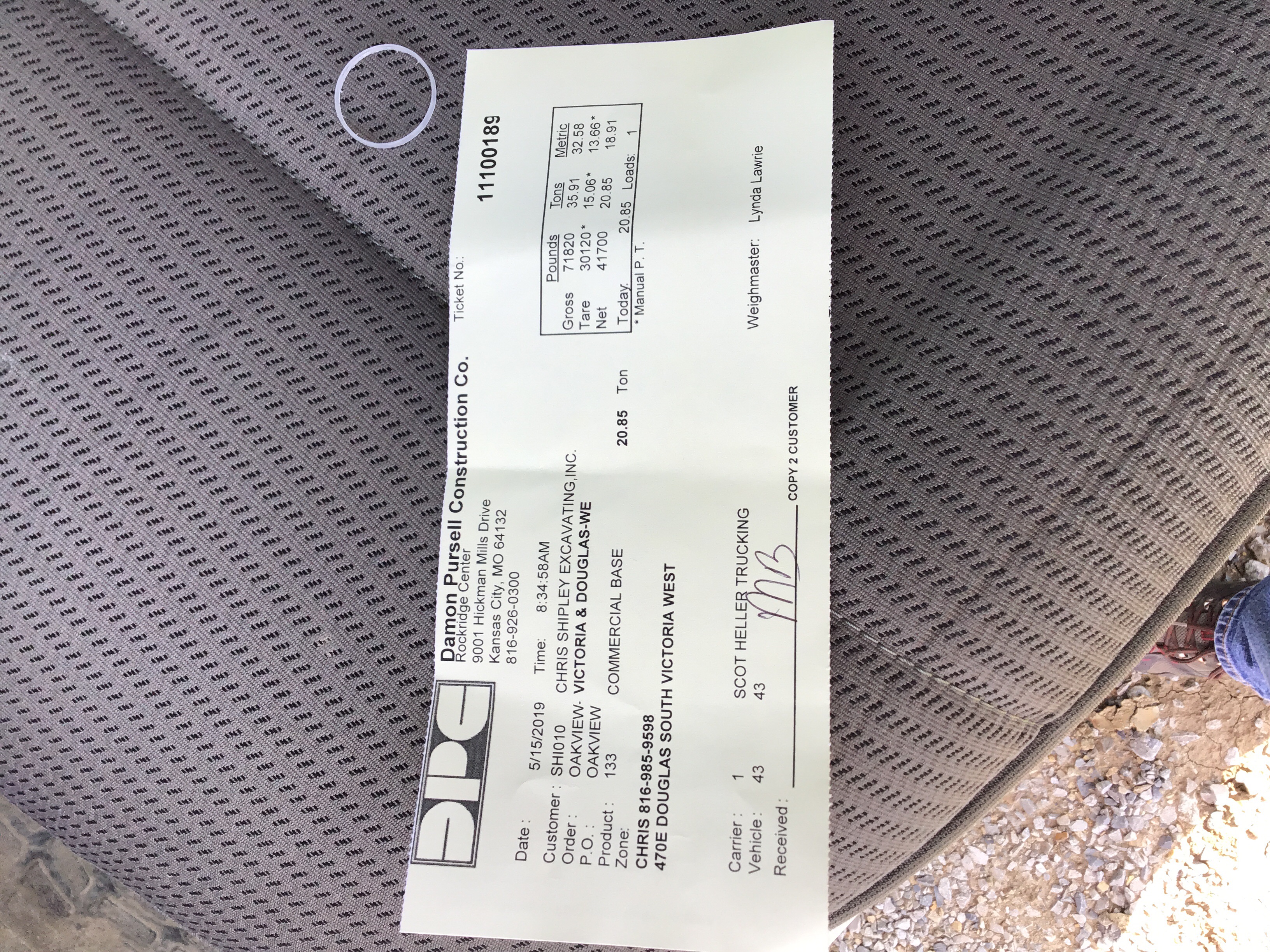

5-16-19 They are laying base rock on all road surfaces and are planning for a proof roll the following week. 2:25pm All base rock has been laid.
Pavement-Surface Passed 07/22/2019
Misc
Informational
06/15/2019
6-15-19 72 degrees cloudy. O’Donnell Way Construction are laying the asphalt base. The temperature out of the trucks has been around 270 degrees and out of the paver about the same. Geotech is doing the testing. Superior is also on site for testing. They finished base at 11:30am. I have collected all type 5 asphalt tickets.
Street - Surface Course Passed 07/22/2019
Misc
Informational
06/20/2019
6-20-19 2:40pm They have laid the surface on the east entrance down to the north south intersection. They are using type 5. There is a delay due to truck shortage. O’Donnell Way Construction are laying the asphalt.Omega has been on site doing the testing.
Erosion Control Inspection Partial 07/24/2019
Misc
Informational
05/31/2019
All erosion control measures are in place properly.
Misc
Informational
05/31/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
05/31/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Misc
Informational
07/24/2019
7-24-19 10:47am There is a crew currently working on the site cleaning up and fixing silt fence. I will do a follow up inspection after they have had time to make corrections.
Erosion Control Inspection Failed 8/21/2019 08/21/2019
Misc
Informational
07/24/2019
All erosion control measures are in place properly.
Misc
Informational
07/24/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
07/24/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Misc
Informational
07/24/2019
7-24-19 10:47am There is a crew currently working on the site cleaning up and fixing silt fence. I will do a follow up inspection after they have had time to make corrections.
Misc
Informational
08/21/2019
8-21-19 11:39am light rain. The silt fence has a small section down on the north side of the enterace coming in off Douglas. Trailer tires have run it over. There is a small section of silt fence down at the enter section on the property due to trailer tires. Gutter buddy is falling in on Victoria on the south side of the job site.
Site Visit Partial 8/21/2019 08/21/2019
Misc
Informational
06/13/2019
Joe Starlin 12/04/2018 3:43 PM Arived at Oak View job site at 8am. Deliverd plans and permit to Bradley O'Connor. We reviewed plans and discussed a game plan moving forward.
Misc
Informational
06/13/2019
8:30am 12/13/18 Arived at Oak View delivered and went over plans for turning lane with Brad O’Connor “Superintendent”.
Misc
Informational
06/13/2019
Joe Starlin 12/18/2018 8:41 AM Visited Oak View project 12/17/18 talked with Brad O'Connor and viewed plans.
Misc
Corrective Action Required
06/13/2019
10:50 am Arived at Oak View and talked with Jim from Beemer Construction. They were taking delivery’s and working on inverts.
Misc
Informational
06/13/2019
Joe Starlin 01/02/2019 3:35 PM Went to Oak View for site visit, there was no activity.
Misc
Informational
06/13/2019
Joe Starlin 01/03/2019 11:30 AM Talked with Brad O'Connor on progress with the site. Beemer Construction crew were working on detention system at the north west side of the site.
Misc
Informational
06/13/2019
I talked with Jim from Beemer Construction Co. They are working on the detention system at the NW corner. Spoke with John Willhoite with Contech who is overseeing the installation. John said the install is going well.
Misc
Corrective Action Required

06/13/2019
1/22/19 Beemer Construction was working on the detention on the south end. Spoke with them and they are going to try to start laying pipe on 1/23/19 weather permitting.
Misc
Corrective Action Required
06/13/2019
1/25/19 11AM Arrived at Oakview and spoke with Brad O’Conner. The crew for Beemer Construction were off loading pipe for the detention system. They said that is all they would be doing for day.
Misc
Informational
06/13/2019
2-12-19 Talked will Brad at Oak View about invert repair and plans moving forward on the overall project.
Misc
Informational
06/13/2019
2-25-19 The Beemer crew is in the process of putting in storm box and pipe.
Misc
Informational
06/13/2019
2-12-19 The Beemer crew corrected the sanitary lines that failed camera test and are waiting 30 days for a new camera test.
Misc
Informational
06/13/2019
2-8-19 The crew is backfilling storm boxes and cleaning up the job site.
Misc
Informational
06/13/2019
3-12-19 The Beemer crew are working on covering the underground detention on the south side of the site.
Misc
Informational
06/13/2019
3-14-19 No crews working today. Spoke with Jim with Beemer they are going to flush sanitary line on Friday 3-15-19
Misc
Informational
06/13/2019
3-15-19 Spoke with Brad, The Beemer crew is setting up for a sanitary line flush and will be working on storm pipe later.
Misc
Informational
06/13/2019
Joe Starlin 03/19/2019 10:23 AM The camera crew where on site for the camera test. The Beemer crew had shut down for the day due to weather. We were not notified had to reach out to Brad the GC to find out.
Misc
Informational
06/13/2019
3-20-19 Gave Brad the GC the plans for the revised water.
Misc
Informational
06/13/2019
3-25-19 Inspector talked with Jim from Beemer, crew is digging, preparing to set vault and are working on water main locate on Douglas.
Misc
Informational
06/13/2019
4-23-19 The Beemer crew preformed a high velocity flush of the water line from 7:15AM to 8:10AM. I returned at 10AM and the crew had placed drain pipe for the roof drain and tied it into the detention. I returned at 1:30pm and the crew had chlorinated the water line. I checked with my strips. It will sit for 24 hours.
Misc
Informational
06/13/2019
5-1-19 No one on site due to weather.
Misc
Informational
06/13/2019

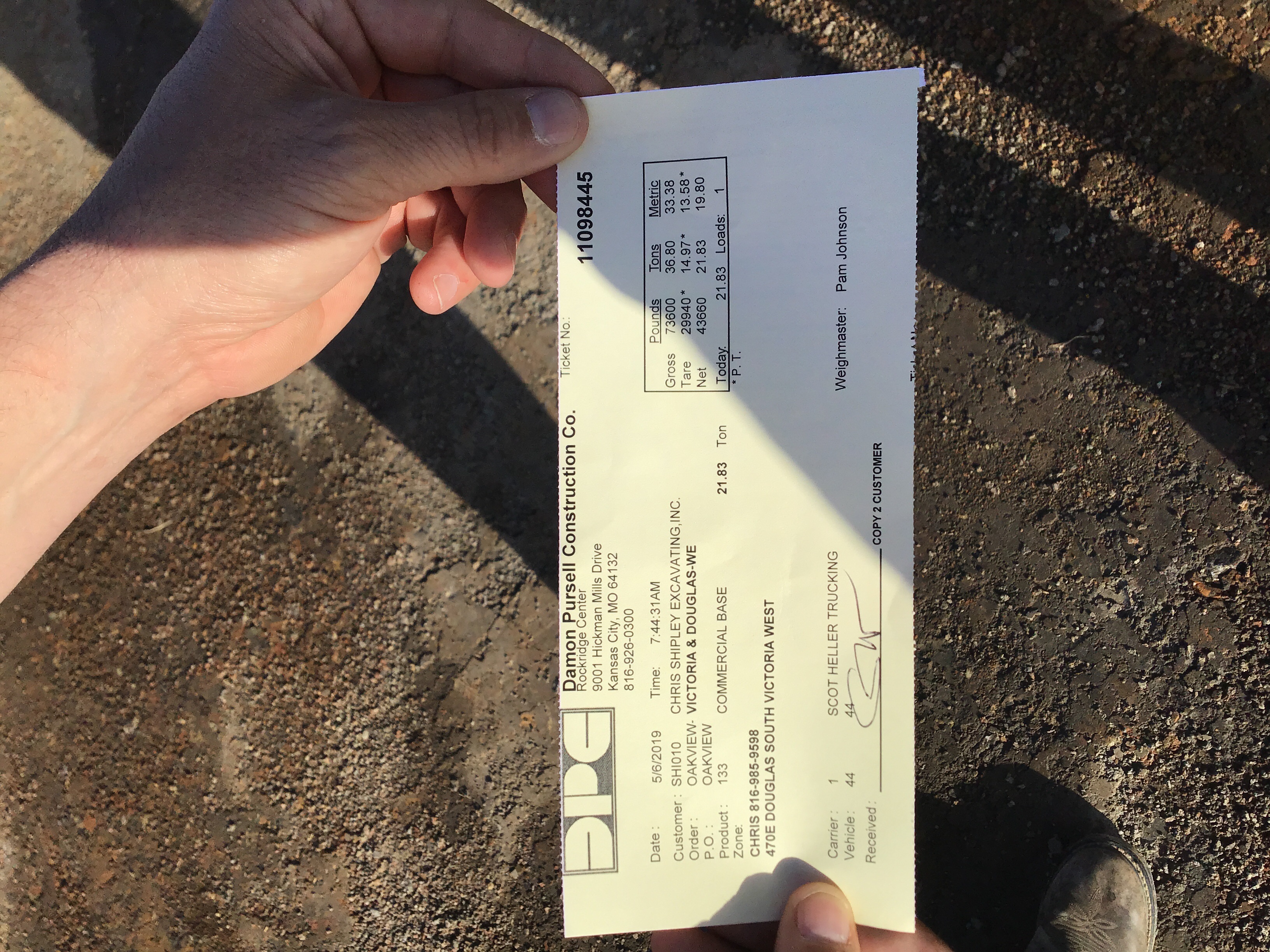

5-17-19 picked up base rock tickets from Shipley.
Misc
Informational
06/13/2019
5-21-19 At Oak View Storage water was rushing out of the NW corner of the site on to Douglas causing flooding. I spoke with Brad O’Connor the GC of the site and he said he would make calls and get erosion control in place to correct the problem.
Misc
Informational
06/13/2019
5-30-19 Steve Robbins and I walked the site observing base rock and erosion control. We determined that both need address due to weather.
Misc
Informational
06/13/2019
6-5-19 There is no activity on site 9:15am
Misc
Informational
06/13/2019
I spoke with Brad the GC at 3:05pm 6-12-19 about what testing is needed for asphalt. I told him we would need on site density and gradation testing along with all other standards we have.
Misc
Informational
08/21/2019
8-21-19 There is no activity on the site.
Erosion Control Inspection Failed 08/28/2019
Misc
Informational
08/21/2019
All erosion control measures are in place properly.
Misc
Informational
08/21/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
08/21/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Misc
Informational
08/21/2019
7-24-19 10:47am There is a crew currently working on the site cleaning up and fixing silt fence. I will do a follow up inspection after they have had time to make corrections.
Misc
Informational
08/21/2019
8-21-19 11:39am light rain. The silt fence has a small section down on the north side of the enterace coming in off Douglas. Trailer tires have run it over. There is a small section of silt fence down at the enter section on the property due to trailer tires. Gutter buddy is falling in on Victoria on the south side of the job site.
Misc
Informational
08/28/2019
8-28-19 We had heavy rain on Monday 8-26-19 There is silt fence down on the south west corner of the site. There is silt ion the road at the west entrance. Silt fence is down on the east side of the road that enters on the west side of the site. Silt fence is still down at the west entrance on the north side. The gutter buddy on Victoria Rd. Is falling into the gutter and needs corrected.
Erosion Control Inspection Partial 9/17/2019 09/17/2019
Misc
Informational
08/28/2019
All erosion control measures are in place properly.
Misc
Informational
08/28/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
08/28/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Misc
Informational
08/28/2019
7-24-19 10:47am There is a crew currently working on the site cleaning up and fixing silt fence. I will do a follow up inspection after they have had time to make corrections.
Misc
Informational
08/28/2019
8-21-19 11:39am light rain. The silt fence has a small section down on the north side of the enterace coming in off Douglas. Trailer tires have run it over. There is a small section of silt fence down at the enter section on the property due to trailer tires. Gutter buddy is falling in on Victoria on the south side of the job site.
Misc
Informational
08/28/2019
8-28-19 We had heavy rain on Monday 8-26-19 There is silt fence down on the south west corner of the site. There is silt ion the road at the west entrance. Silt fence is down on the east side of the road that enters on the west side of the site. Silt fence is still down at the west entrance on the north side. The gutter buddy on Victoria Rd. Is falling into the gutter and needs corrected.
Misc
Informational
09/17/2019
9-17-19 The erosion controls have been corrected and appear to be holding up at this time. There is some dirt on the road that need swept up. I will reach out to the contractor to see about getting this done.
Erosion Control Inspection Partial 10/31/2019 10/31/2019
Misc
Informational
09/17/2019
All erosion control measures are in place properly.
Misc
Informational
09/17/2019
5-22-19 The silt fence is down on the NE corner of the site as well as areas on the west side of the site. Spoke with the GC and he said they will make corrections in the AM on 5-23-19.
Misc
Informational
09/17/2019
5-31-19 Steven Conrick and I met with Brad the on site GC. We walked the intire job site and went over all erosion control corrections that need to be repaired and or added to including all storm box inlets. A burn will be placed at NE side of the site to help slow water and minimize erosion in that area. Brad assured us that all repairs will be taken care of in a timely manner. Brad will also be including me on the emails that pertain to SWPPP.
Misc
Informational
09/17/2019
7-24-19 10:47am There is a crew currently working on the site cleaning up and fixing silt fence. I will do a follow up inspection after they have had time to make corrections.
Misc
Informational
09/17/2019
8-21-19 11:39am light rain. The silt fence has a small section down on the north side of the enterace coming in off Douglas. Trailer tires have run it over. There is a small section of silt fence down at the enter section on the property due to trailer tires. Gutter buddy is falling in on Victoria on the south side of the job site.
Misc
Informational
09/17/2019
8-28-19 We had heavy rain on Monday 8-26-19 There is silt fence down on the south west corner of the site. There is silt ion the road at the west entrance. Silt fence is down on the east side of the road that enters on the west side of the site. Silt fence is still down at the west entrance on the north side. The gutter buddy on Victoria Rd. Is falling into the gutter and needs corrected.
Misc
Informational
09/17/2019
9-17-19 The erosion controls have been corrected and appear to be holding up at this time. There is some dirt on the road that need swept up. I will reach out to the contractor to see about getting this done.
Misc
Informational
10/31/2019
10-31-19 29 degrees outside with snow. The erosion controls on the site are in place with one small area of silt fence down on the south west corner.
Detention Basin Passed 11/06/2020
Misc
Informational
03/11/2019

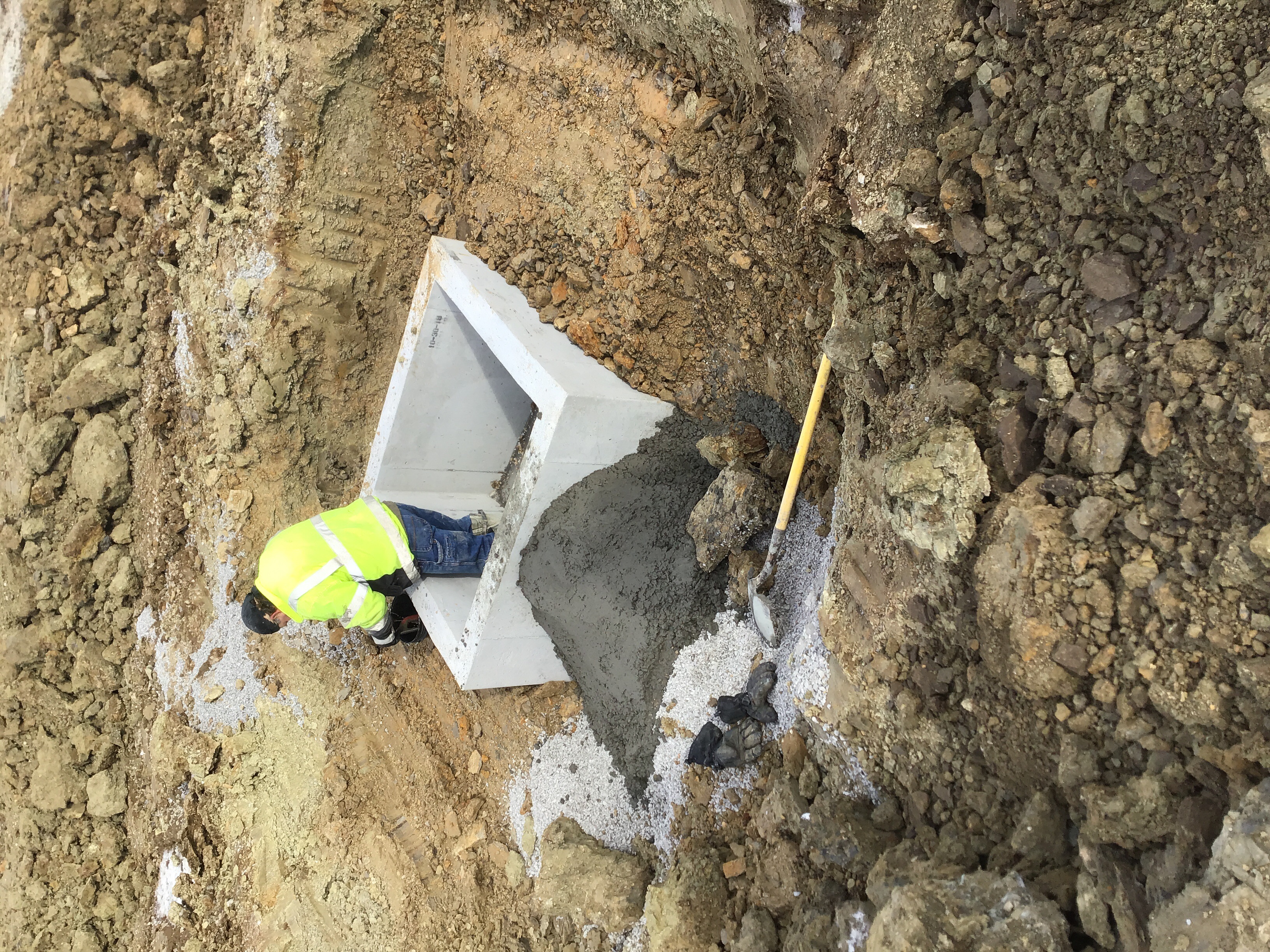

The 13,673 cu. ft. underground detention system has been installed and covered. The inspector for Contech Engineered Solutions John Willhoite was on site daily for the installation. He will be sending a report on the detention system.
Misc
Informational
03/11/2019
3-11-19 The Beemer crew are currently backfilling the underground detention on the south side of site. The third party inspector is on site.
Commercial Curb Inspection Passed 11/06/2020
Misc
Informational
06/05/2019

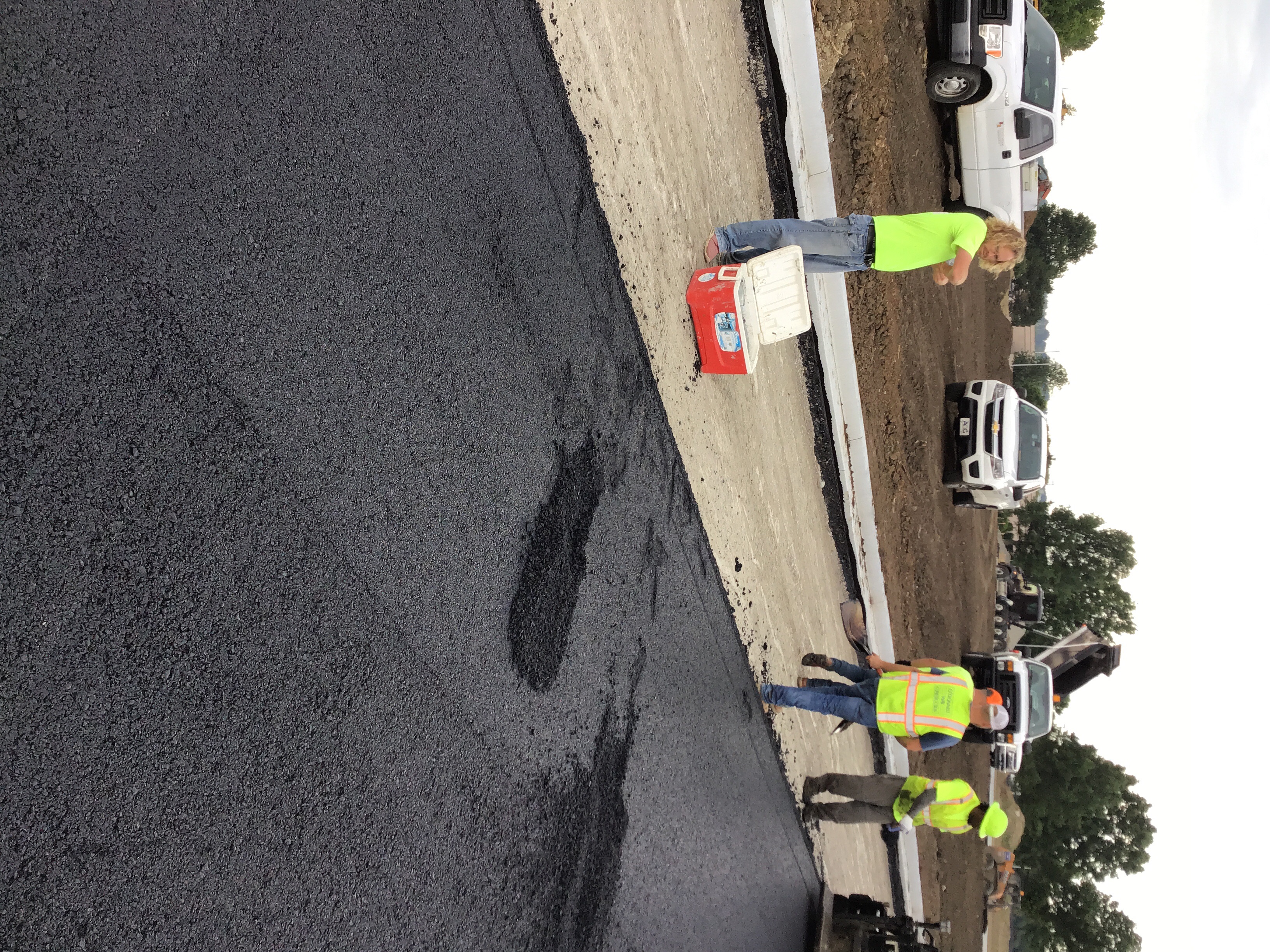

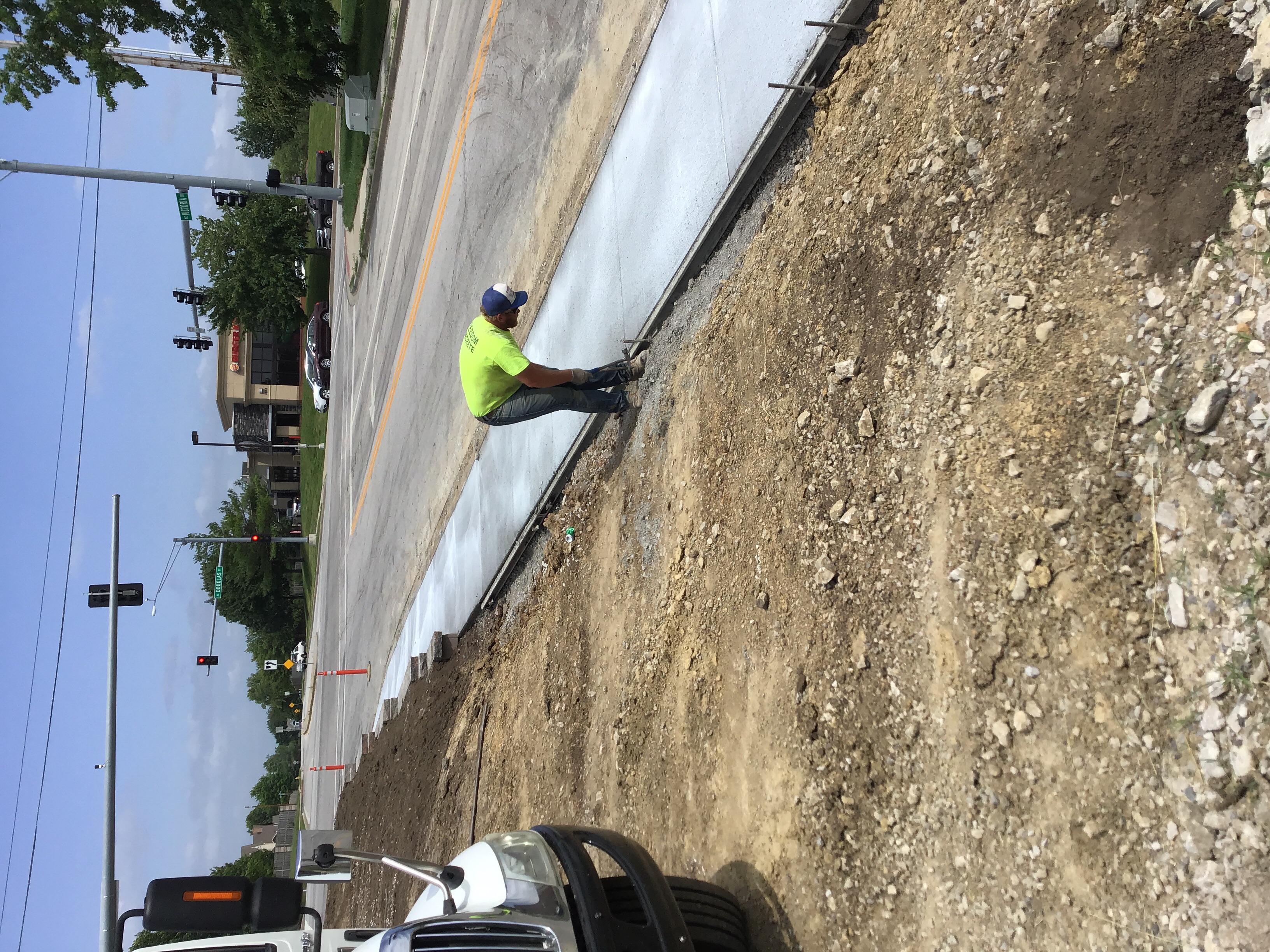

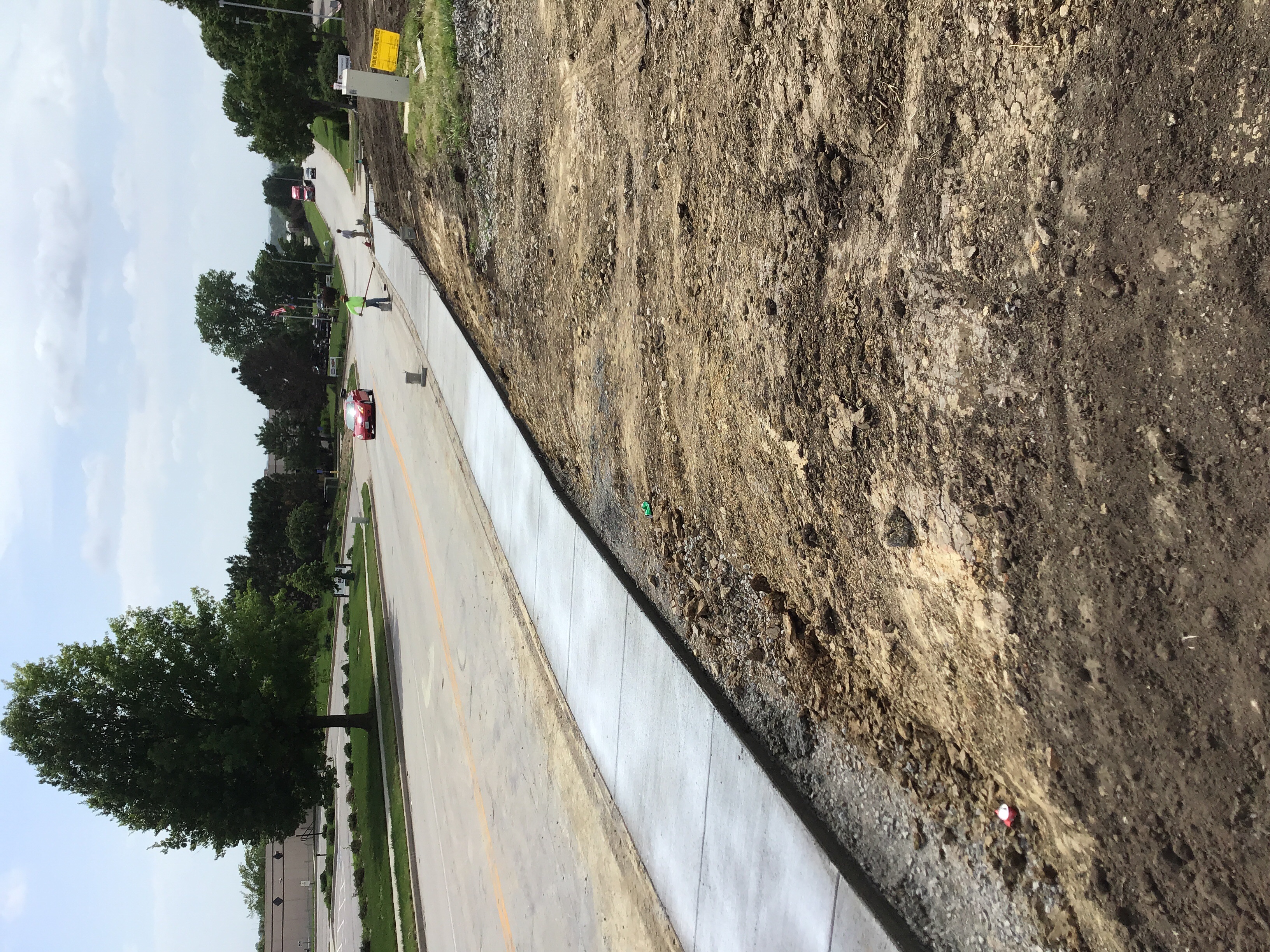

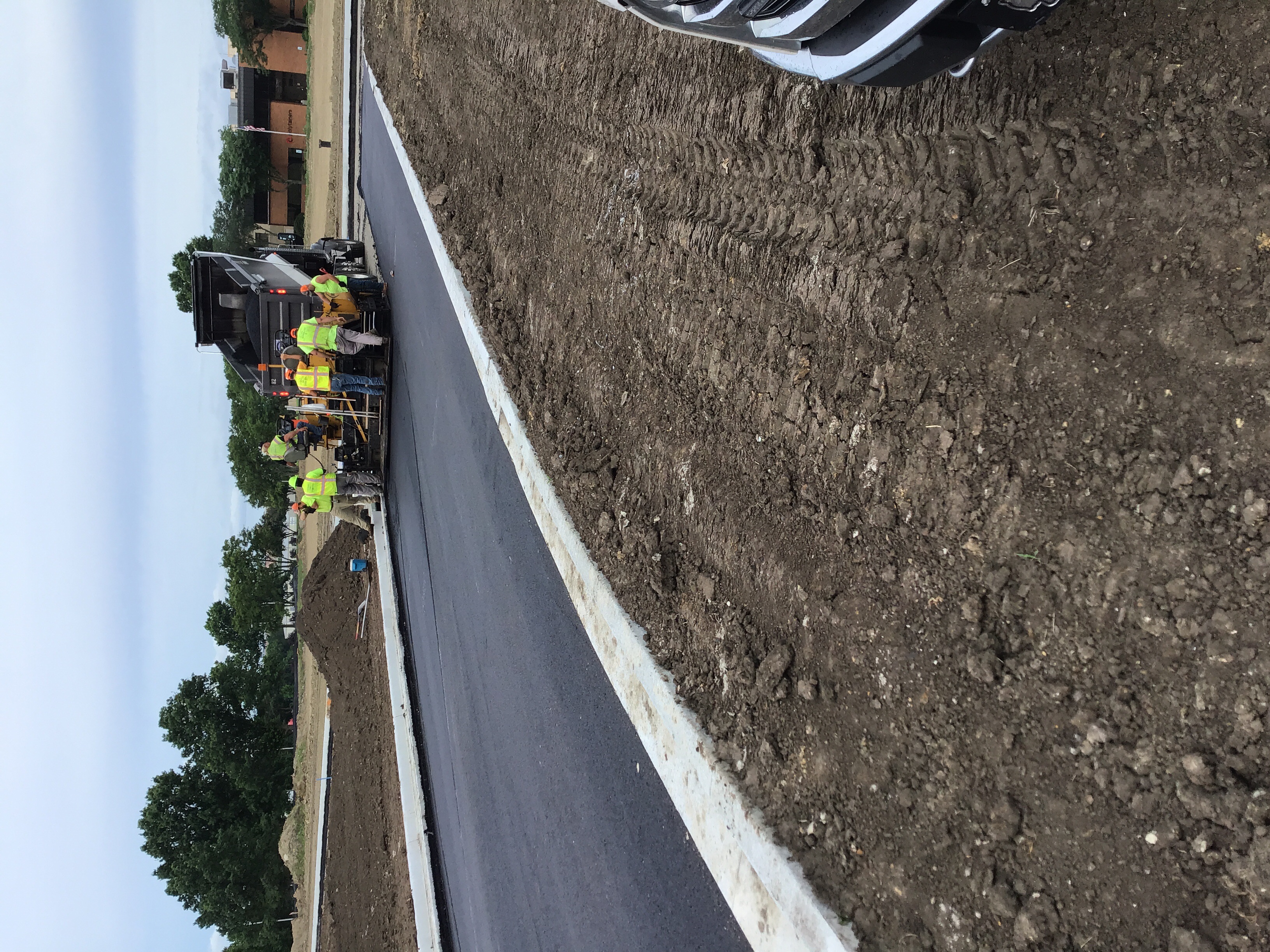

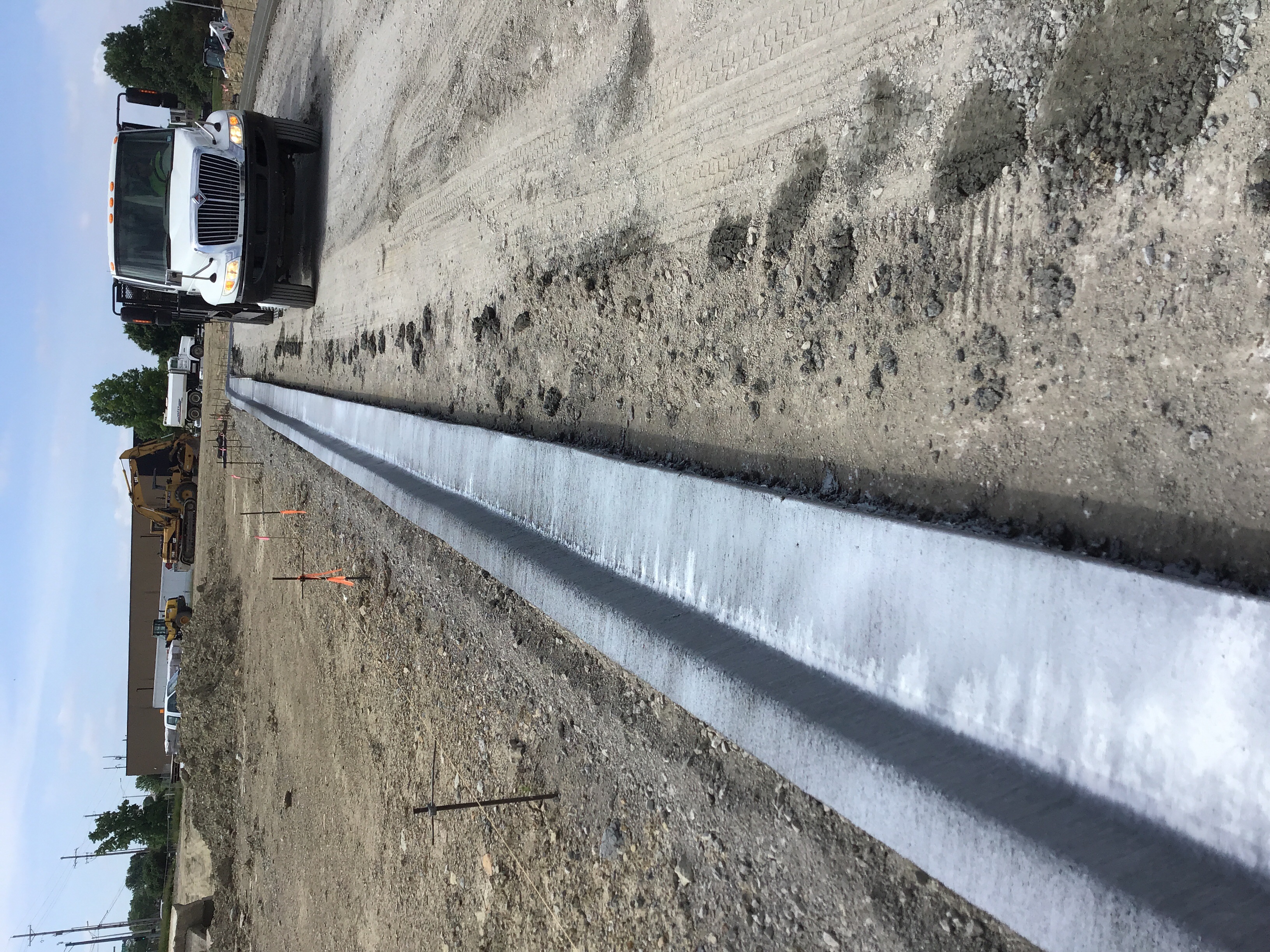

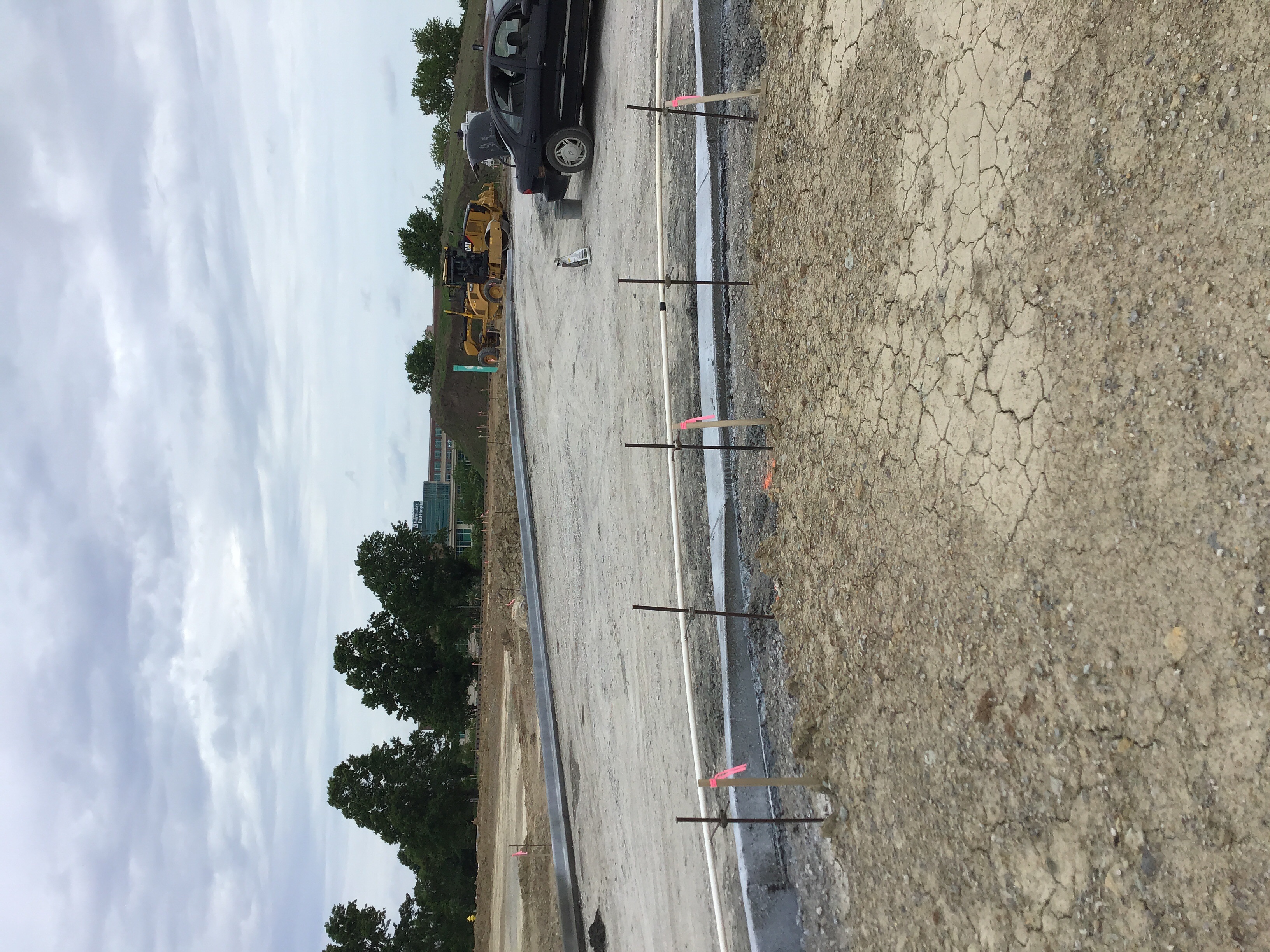

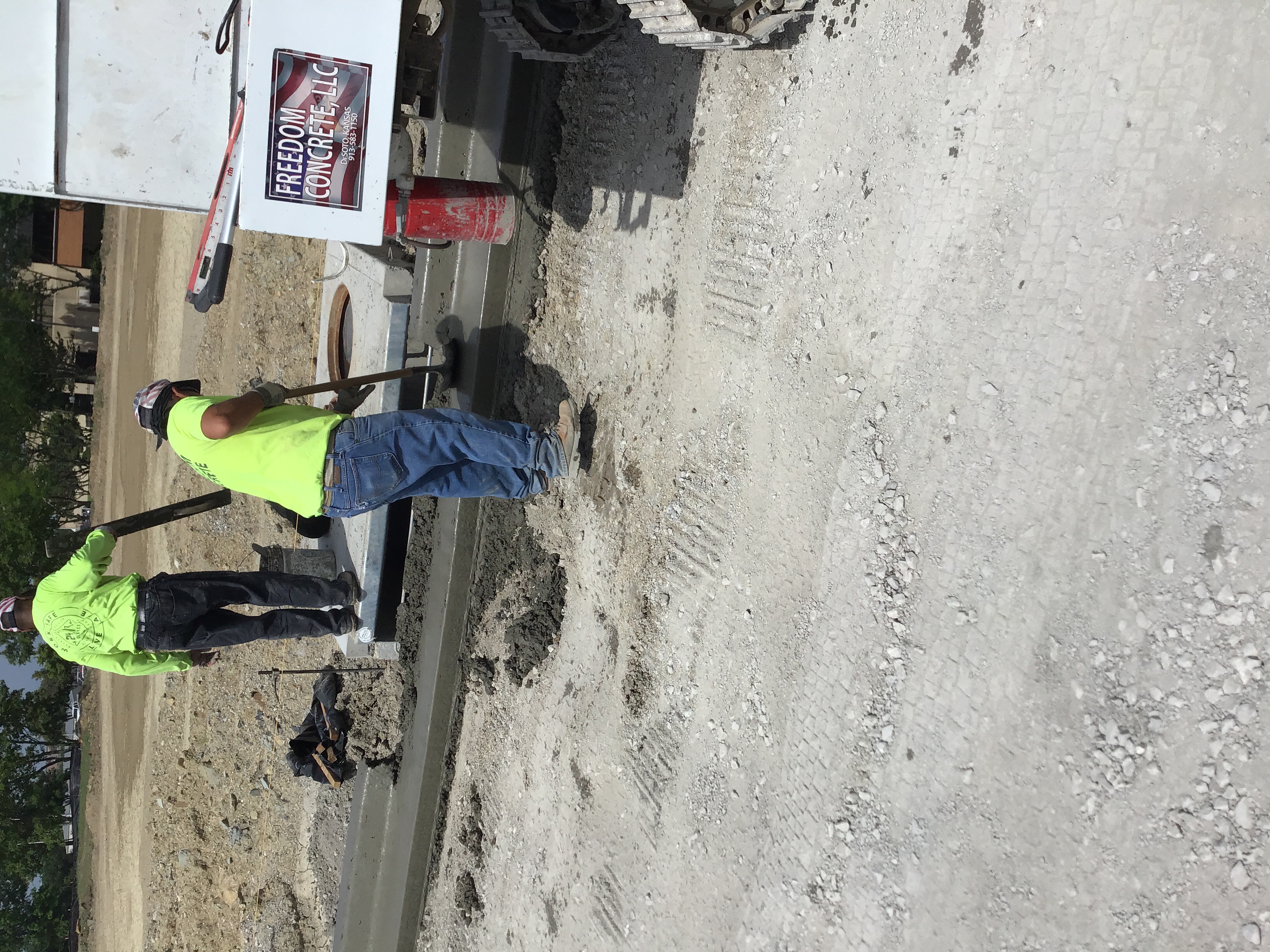

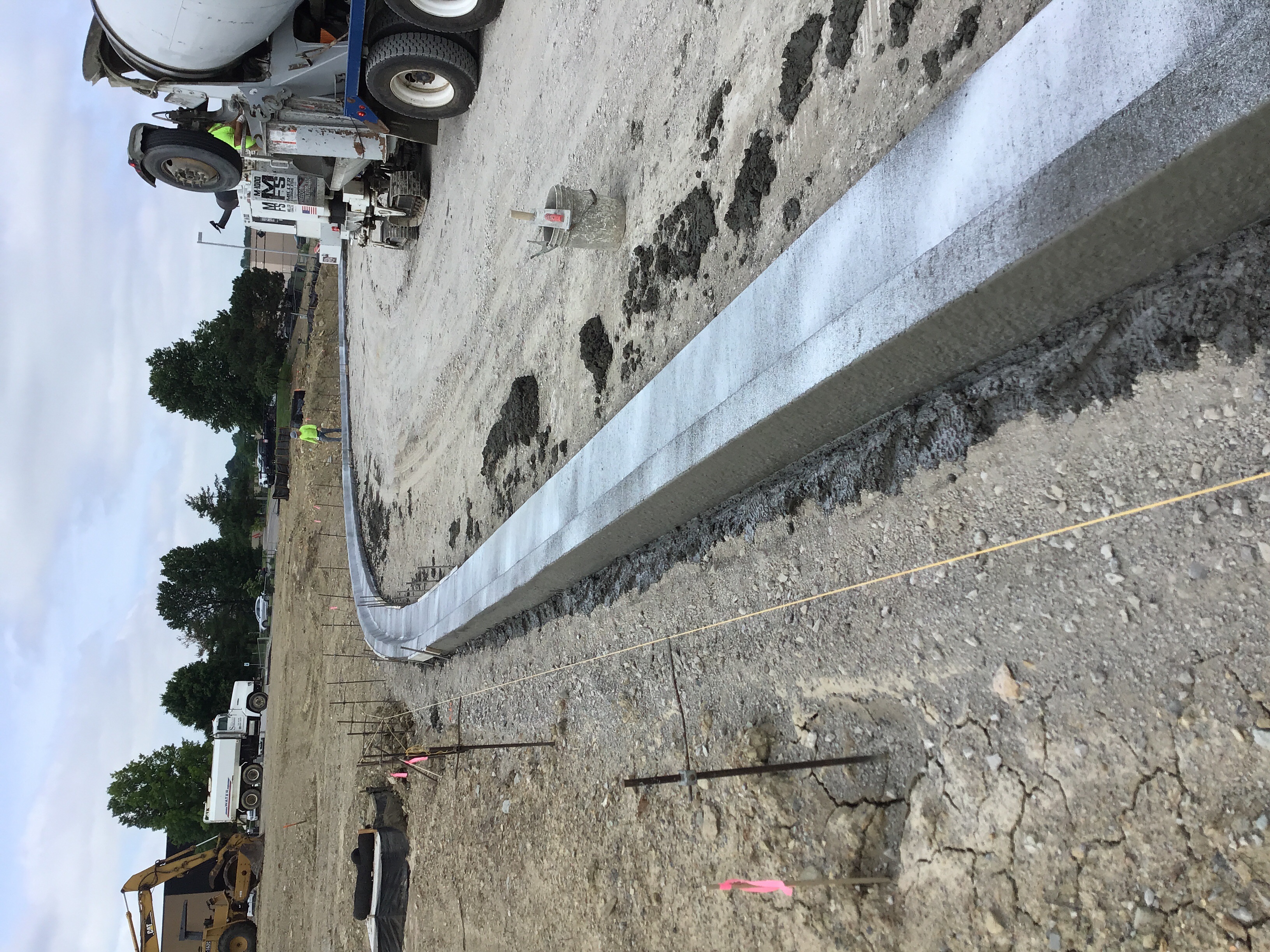

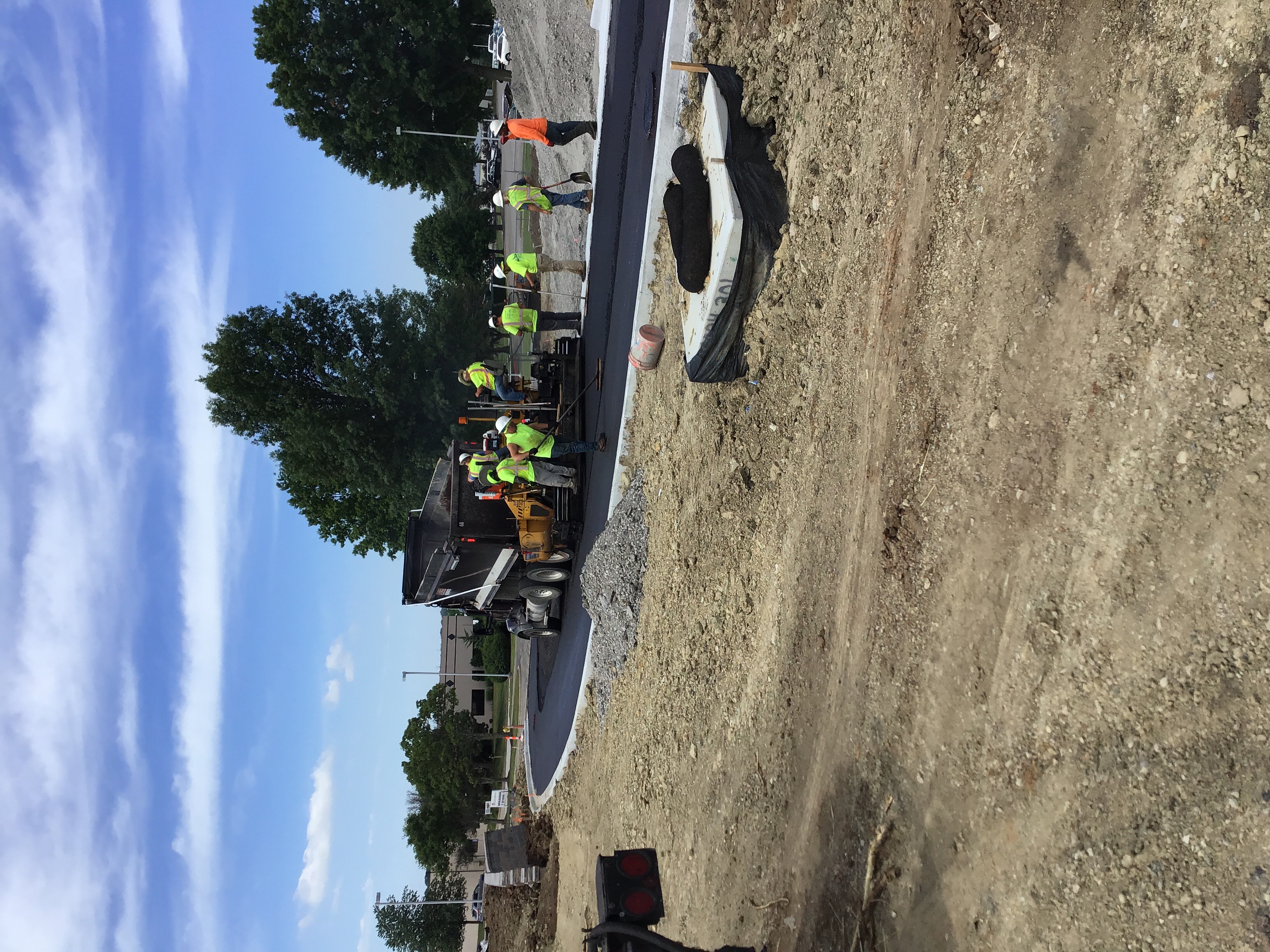

70 degrees cloudy. Freedom Concrete started pouring curb at 7:30am on the NE side. They did not start curing until 9:20am. I asked them why they were waiting, there reply was they wanted it to set up faster. I explained to them this is not are common practice and that they should be curing right away. They chose to ignore me. When they started curing I pointed out to the GC the cure was light, he said he was good with it because he will hold the concrete company accountable. At 11:30am none of the back side of the curb has been cured at this point. I spoke with the forman of the crew and he said he would cure the back side of the curb when all the curb is poured approximately 12:30pm. 1:15pm 81 degrees, starting to sprinkle. Curb is in except for some hand work. The back side of curb is cured but poorly.
Master Drainage As-built Inspection Passed 12/22/2020 12/18/2020
Documents & Images

No documents are currently available for viewing.

Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
