Planning Application Status

PL2019401




 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PL2019401
DCI - LEE'S SUMMIT
Commercial Final Development Plan
Commercial Final Development Plan
Approved
12/06/2019
PREMIERLIFE REAL ESTATE HOLDING
Locations
Contacts
RANDALL DOVER ARCHITECT, Address:4121 HILLSBORO RD, STE 303, Phone:(615) 251-3388
CATALYST DESIGN GROUP, Address:5016 CENTENNIAL BLVD, SUITE 200, Phone:(615) 476-7238
PREMIERLIFE REAL ESTATE HOLDING, Address:400 NW MURRAY RD
Reviews
Review Type Outcome Est. Completion Date Completed
Engineering Review No Comments 04/01/2021 03/26/2021
Gene Williams, P.E.
DE Contact Field Eng. Inspector
Corrective Action Required
03/25/2021

Contact Field Engineering Inspections at (816) 969-1200 at least 48 hours prior to the onset of construction.
DE Contact ROW Inspector
Corrective Action Required
03/25/2021

Prior to any activities within the right-of-way, a separate temporary traffic control permit is required. The permit application is available online. Please contact (816) 969-1800 to obtain the required permit.
DE Future Repair Work
Corrective Action Required
03/25/2021

Please be aware that any future repair work to public infrastructure (e.g., water main repair, sanitary sewer repair, storm sewer repair, etc.) within public easements will not necessarily include the repair of pavement, curbing, landscaping, or other private improvements which are located within the easement.
DE C&O #12 Cut & Fill
Corrective Action Required
03/25/2021

Any cut and / or fill operations, which cause public infrastructure to exceed the maximum / minimum depths of cover shall be mitigated by relocating the infrastructure vertically and / or horizontally to meet the specifications contained within the City’s Design and Construction Manual.
DE C&O #03 Eng & Insp Fees
Corrective Action Required
03/25/2021

All Engineering Plan Review and Inspection Fees, $42,030.11,shall be paid prior to approval of the associated engineering plans and prior to the issuance of any infrastructure permits or the start of construction (excluding land disturbance permit).
Engineering Review Corrections 03/15/2021 03/13/2021
Gene Williams, P.E.
DE Contact Field Eng. Inspector
Corrective Action Required
03/08/2021

Contact Field Engineering Inspections at (816) 969-1200 at least 48 hours prior to the onset of construction.
DE Contact ROW Inspector
Corrective Action Required
03/08/2021

Prior to any activities within the right-of-way, a separate temporary traffic control permit is required. The permit application is available online. Please contact (816) 969-1800 to obtain the required permit.
DE Future Repair Work
Corrective Action Required
03/08/2021

Please be aware that any future repair work to public infrastructure (e.g., water main repair, sanitary sewer repair, storm sewer repair, etc.) within public easements will not necessarily include the repair of pavement, curbing, landscaping, or other private improvements which are located within the easement.
DE C&O #12 Cut & Fill
Corrective Action Required
03/08/2021

Any cut and / or fill operations, which cause public infrastructure to exceed the maximum / minimum depths of cover shall be mitigated by relocating the infrastructure vertically and / or horizontally to meet the specifications contained within the City’s Design and Construction Manual.
DE C&O #03 Eng & Insp Fees
Corrective Action Required
03/08/2021

All Engineering Plan Review and Inspection Fees, $42,030.11,shall be paid prior to approval of the associated engineering plans and prior to the issuance of any infrastructure permits or the start of construction (excluding land disturbance permit).
Engineering Review Approved with Conditions 07/15/2020 07/10/2020
Gene Williams, P.E.
DE Contact Field Eng. Inspector
Corrective Action Required
07/08/2020

Contact Field Engineering Inspections at (816) 969-1200 at least 48 hours prior to the onset of construction.
DE Contact ROW Inspector
Corrective Action Required
07/08/2020

Prior to any activities within the right-of-way, a separate temporary traffic control permit is required. The permit application is available online. Please contact (816) 969-1800 to obtain the required permit.
DE Future Repair Work
Corrective Action Required
07/08/2020

Please be aware that any future repair work to public infrastructure (e.g., water main repair, sanitary sewer repair, storm sewer repair, etc.) within public easements will not necessarily include the repair of pavement, curbing, landscaping, or other private improvements which are located within the easement.
DE C&O #12 Cut & Fill
Corrective Action Required
07/08/2020

Any cut and / or fill operations, which cause public infrastructure to exceed the maximum / minimum depths of cover shall be mitigated by relocating the infrastructure vertically and / or horizontally to meet the specifications contained within the City’s Design and Construction Manual.
DE C&O #03 Eng & Insp Fees
Corrective Action Required
07/08/2020

All Engineering Plan Review and Inspection Fees, $42,030.11,shall be paid prior to approval of the associated engineering plans and prior to the issuance of any infrastructure permits or the start of construction (excluding land disturbance permit).
Engineering Review Approved with Conditions 06/30/2020 06/29/2020
Gene Williams, P.E.
DE Contact Field Eng. Inspector
Corrective Action Required
06/23/2020

Contact Field Engineering Inspections at (816) 969-1200 at least 48 hours prior to the onset of construction.
DE Contact ROW Inspector
Corrective Action Required
06/23/2020

Prior to any activities within the right-of-way, a separate temporary traffic control permit is required. The permit application is available online. Please contact (816) 969-1800 to obtain the required permit.
DE Future Repair Work
Corrective Action Required
06/23/2020

Please be aware that any future repair work to public infrastructure (e.g., water main repair, sanitary sewer repair, storm sewer repair, etc.) within public easements will not necessarily include the repair of pavement, curbing, landscaping, or other private improvements which are located within the easement.
DE C&O #12 Cut & Fill
Corrective Action Required
06/23/2020

Any cut and / or fill operations, which cause public infrastructure to exceed the maximum / minimum depths of cover shall be mitigated by relocating the infrastructure vertically and / or horizontally to meet the specifications contained within the City’s Design and Construction Manual.
DE C&O #03 Eng & Insp Fees
Corrective Action Required
06/23/2020

All Engineering Plan Review and Inspection Fees, $42,030.11,shall be paid prior to approval of the associated engineering plans and prior to the issuance of any infrastructure permits or the start of construction (excluding land disturbance permit).
Planning Review No Comments 01/30/2020 01/27/2020
Shannon McGuire
Fire Review Approved with Conditions 01/22/2020 01/23/2020
Mike Weisenborn
Code Statement
Corrective Action Required
01/14/2020

All issues pertaining to life safety and property protection from the hazards of fire, explosion or dangerous conditions in new and existing buildings, structures and premises, and to the safety to fire fighters and emergency responders during emergency operations, shall be in accordance with the 2018 International Fire Code.
Engineering Review Approved with Conditions 01/22/2020 01/22/2020
Gene Williams, P.E.
DE Engineers Estimate
Resolved
01/31/2020

The Engineer’s Estimate of Probable Construction Costs must be submitted prior to approval of the Final Development Plan. A lump sum estimate is not sufficient. The estimate must be sealed, itemized, and include all site development costs, including unit prices for each activity. The Engineering Plan Review and Inspection Fee is based on this estimate, and calculated at 3% of the total, plus a nominal $100 per trip fee for water sample observation and collection, and a nominal right of way fee of $80.
DE Contact Field Eng. Inspector
Corrective Action Required
01/22/2020

Contact Field Engineering Inspections at (816) 969-1200 at least 48 hours prior to the onset of construction.
DE Contact ROW Inspector
Corrective Action Required
01/22/2020

Prior to any activities within the right-of-way, a separate temporary traffic control permit is required. The permit application is available online. Please contact (816) 969-1800 to obtain the required permit.
DE Future Repair Work
Corrective Action Required
01/22/2020

Please be aware that any future repair work to public infrastructure (e.g., water main repair, sanitary sewer repair, storm sewer repair, etc.) within public easements will not necessarily include the repair of pavement, curbing, landscaping, or other private improvements which are located within the easement.
DE C&O #12 Cut & Fill
Corrective Action Required
01/22/2020

Any cut and / or fill operations, which cause public infrastructure to exceed the maximum / minimum depths of cover shall be mitigated by relocating the infrastructure vertically and / or horizontally to meet the specifications contained within the City’s Design and Construction Manual.
DE C&O #03 Eng & Insp Fees
Corrective Action Required
01/31/2020

All Engineering Plan Review and Inspection Fees, $42,030.11,shall be paid prior to approval of the associated engineering plans and prior to the issuance of any infrastructure permits or the start of construction (excluding land disturbance permit).
Traffic Review No Comments 01/22/2020 01/21/2020
Michael Park
Building Codes Review No Comments 01/22/2020 01/16/2020
Joe Frogge
Planning Review Corrections 01/22/2020 01/15/2020
Shannon McGuire
Corrective Action Required
01/15/2020

Comments 6 & 7 from the Applicants Letter dated 12-20-19 were not addressed. #6 - Please provide the manufacturer’s specification sheets for proposed mechanical equipment to be used (roof or ground mounted). #7 - Please show the location, size and materials to be used in all screening of rooftop mechanical equipment. A dashed line indicating the roof line and rooftop mechanical equipment. #7 may be best addressed by dashing in the location/height of the RTUs on sheets A5.0 & 5.1.
Engineering Review Corrections 12/20/2019 12/20/2019
Gene Williams, P.E.
Corrective Action Required
12/20/2019

Please refer to page 4 of the "Drainage Design Summary" dated Jul. 25, 2019 (hereinafter referred to as "the stormwater study"). Under "Proposed Condition Analysis", the bypass flow is discussed without any analysis of pre-development versus post-developed flow from this sub-area. Will the post-developed peak flow be less than the pre-development peak flow? How much lower will this peak flow be in relation to the pre-developed condition?
Corrective Action Required
12/20/2019

There appear to be contradictions within the body of the report concerning this system, including the statement "...the grated casting of the outlet structure is set just above the 100 year storm elevation of 966.20 to serve as an emergency overflow weir." However, the appendix shows the grated top was included in the routing calculations for the primary outlet system. Is this weir combined with the earthen spillway to act in an emergency capacity, to carry the clogged condition/zero available storage flow? If 100% clogged and zero available storage, how will the grated top function in this capacity? Please reconcile these discrepancies.
Corrective Action Required
12/20/2019

The stormwater study did not discuss (in detail) the specific design of the emergency overflow spillway system. A discussion of the required freeboard between the 100 year (nominal) water surface elevation within the basin, and the crest of the emergency spillway must be discussed. A discussion of the freeboard for the 100% clogged condition/zero available storage 100 year water surface elevation and the top of the dam must also be re-analyzed based on the above comments.
Corrective Action Required
12/20/2019

There appears to be confusion concerning the design requirements for an emergency overflow system. This system is not intended to be utilized for anything other than the 100% clogged condition/zero available storage event. According to the pond setup sheets within the appendix, it appears the grated outlet structure top is being utilized for the design events.
Corrective Action Required
12/20/2019

What analysis was performed to determine the effects of the upstream drainage within the underground system, on the performance of the outlet structure? Will there be any effect on the hydraulic characteristics of the outgoing flow from the outlet structure?
Corrective Action Required
12/20/2019

Sheet C5.0: Plan views are provided for storm lines, but profile views are also required for all storm lines greater than 6 inches in diameter. This would also include the pipe beneath the detention basin.
Corrective Action Required
12/20/2019

Sheet C5.0: A reference to the sheet number and detail number should be called-out for the outlet structure.
Corrective Action Required
12/20/2019

Sheet C5.0: Rip rap appears to be shown, with no corresponding instructions concerning sizing, thickness, length, width, geofabric, quantity, etc.
Corrective Action Required
12/20/2019

Sheet C5.0: As discussed during the Preliminary Development Plan phase of this project, there is concern about drainage to the south, in the vicinity of the earthen emergency spillway. According to your calculations contained within the stormwater study, it would appear the small berm shown on the grading plan will be insuffient to contain an emergency overflow event with sufficient freeboard to protect the property owner to the south. Suffient grading must be provided, with a minimum 2.0 feet of freeboard to prevent migration of emergency flows towards this property to the south. As shown, it would appear flooding would be likely.
Corrective Action Required
12/20/2019

Sheet C6.0: Size and type of material must be called-out for the domestic water line from the main to the meter. For the domestic and irrigation water supply lines, these lines must be copper. For the domestic and irrigation lines, they must be either 3/4", 1", or 2". In addition, copper must be specified a minimum of 10 feet beyond the meter.
Corrective Action Required
12/20/2019

Sheet C6.0: Street restoration for an arterial street was omitted from the plans. The note "remove and repair as per City standards" is not sufficient. Is this a concrete street? If so, full panel removal and replacement shall be required. The replacement must either match the existing design, or be designed to a higher standard. Please contact our Records Technician in Public Works at 969-1800, and obtain the as-built Record Drawings for this street section, and ensure the full-panel removal and replacement matches the existing design, or is a better design.
Corrective Action Required
12/20/2019

A temporary traffic control permit must be obtained from Public Works prior to approval of the Final Development Plan. This permit includes a requirement that a temporary traffic control plan be developed. No work within the Pryor Rd. right of way shall be allowed until this permit has been issued by Public Works.
Corrective Action Required
12/20/2019

A cut-in tee must be specified for the fire line. A wet tap shall not be allowed.
Corrective Action Required
12/20/2019

A sanitary sewer cleanout is shown in what appears to be the middle of the existing sidewalk?
Corrective Action Required
12/20/2019

Sheet C7.0: The asphalt pavement sections do not follow the Unified Development Ordinance (UDO) in terms of pavement thickness, and chemically-stabilized subgrade or geogrid. Please review the UDO for specific requirements. In general, 1.5 inches of surface course over 4 inches of base course asphaltic concrete is required for normal pavement, with either chemically-stabilized subgrade or geogrid beneath a layer of 6 inch aggregate. Add one (1) inch of asphaltic concrete base course for heavy duty pavement, with all other design parameters the same.
Corrective Action Required
12/20/2019

Sheet C7.0: The curb and gutter section is not quite correct. The aggregate base and chemically-stabilized subgrade or geogrid must be extended a minimum of one (1) foot beyond the back of curb.
Corrective Action Required
12/20/2019

Sheet C7.1: A post-indicator valve is shown on the plans, but does not appear to be a part of this project. Please remove.
Corrective Action Required
12/20/2019

Sheet C7.2: What design is being provided to drain the backflow vault sump? There are several methods that can be used to drain the sump, either by daylighting if available, tying to a storm structure, or construction of an infiltration trench if no other option is available.
Corrective Action Required
12/20/2019

Sheet C7.2: An air-release assembly is shown, but does not appear to be a part of this project. Please remove.
Corrective Action Required
12/20/2019

A prominent note must be provided stating that the detention basin and outlet structure shall be constructed first.
Corrective Action Required
12/20/2019

The concrete sidewalk detail shown on Sheet C7.0 is missing the 4 inch aggregate leveling course layer.
Corrective Action Required
12/20/2019

There are no notes concerning the restoration of the sidewalk in the southeast corner of the project (i.e., where the new sanitary sewer lateral is being constructed).
Corrective Action Required
12/20/2019

The 100 year water surface elevation must be shown graphically and numerically in some fashion. This can be done on the grading plan or other appropriate sheet.
Corrective Action Required
12/20/2019

A note must be provided stating that an as-graded and as-built drawing shall be submitted to the City and reviewed by the City for the detention basin. This shall be required prior to issuance of a Certificate of Substantial Completion.
Corrective Action Required
12/20/2019

It does not appear that an analysis was performed on the receiving storm system. We are showing a 24 inch pipe at the receiving end, with upstream contributions to that point. An analysis shall be required.
Corrective Action Required
12/20/2019

An Engineer's Estimate of Probable Construction Costs is required prior to formal approval of the Final Development Plan. This estimate is used to determine the Engineering Plan Review and Inspection Fee. This estimate should include all sitework necessary to complete the project.
Planning Review Corrections 12/20/2019 12/19/2019
Shannon McGuire
Corrective Action Required
12/19/2019

Please provide an application form signed by both the property owner and the applicant.
Corrective Action Required
12/19/2019

Please resubmit plan sheets not exceed the maximum size of 24 inches by 36 inches with one inch border.
Corrective Action Required
12/19/2019

The pilasters on the north side of the proposed building protrude into the sidewalk and appears to reduce the walkable surface significantly, roughly 3’. As proposed a vehicle parking in ADA stalls on the north side of the building would block the sidewalk given the 2’ overhand allowance for the shorter stall. A 4’ clear path must be maintained for the accessible route from the parking stalls to the facility. The parking stalls may be reduced to 9’ wide x 17’ deep parking spaces when the parking space abuts a 6’ wide sidewalk or when abutting a curbed open green/landscaped space.
Corrective Action Required
12/19/2019

Are you proposing any wall mounted lighting? If so please provide the location, height, intensity and type of outside lighting fixtures. Please also provide the manufacturer’s specification sheets for all proposed exterior lighting to include both parking lot pole mounted and wall mounted fixtures. The specification sheets shall indicate the exact fixture to be used.
Corrective Action Required
12/19/2019

Is there any ground mounted equipment being proposed? Please provide the location, size, and type of material to be used in all screening of ground mounted mechanical equipment.
Corrective Action Required
12/19/2019

Please provide the manufacturer’s specification sheets for proposed mechanical equipment to be used (roof or ground mounted).
Corrective Action Required
12/19/2019

Please show the location, size and materials to be used in all screening of rooftop mechanical equipment. A dashed line indicating the roof line and rooftop mechanical equipment.
Corrective Action Required
12/19/2019

A high Impact landscaping buffer is required along the south property line. This includes the requirement of a fence. During the PDP a modification was granted to place the fence 3’ north of the south property line. Please show the fence location on the landscaping plan and provide details of the proposed fencing materials.
Corrective Action Required
12/19/2019

Please label the proposed materials for the dumpster enclosure gate.
Corrective Action Required
12/19/2019

Please label the distance the southernmost parking lot light sits back from the south property line.
Traffic Review No Comments 12/20/2019 12/18/2019
Michael Park
Fire Review Approved with Conditions 12/20/2019 12/16/2019
Jim Eden
Code Statement
Corrective Action Required
12/20/2019

All issues pertaining to life safety and property protection from the hazards of fire, explosion or dangerous conditions in new and existing buildings, structures and premises, and to the safety to fire fighters and emergency responders during emergency operations, shall be in accordance with the 2018 International Fire Code.
Building Codes Review No Comments 12/20/2019 12/12/2019
Joe Frogge
Fees
Paid Fees Amount Paid Owing Date Paid
9110077-Final Development Plan fee $600.00 $600.00 Paid 12/06/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Hearings
Title Location Date Time
Documents & Images
Date Uploaded File Type Document Name
12/06/2019 Receipt Receipt for transaction: 2019-007613
12/06/2019 Letter Routing Sheet - FDP
12/10/2019 Plans PL2019401 - DRAINAGE DESIGN SUMMARY
12/10/2019 Plans PL2019401 - Planning Final Application plans
12/20/2019 Letter Applicant Letter - FDP (DFDP)
01/14/2020 Letter Resubmittal Routing Sheet - FDP
01/14/2020 Plans 2020-01-10 Planning rev. 2.pdf DCI
01/14/2020 Engineer Report/Study 20180111_2020-01-10 DRAINAGE DESIGN SUMMARY
01/17/2020 Plans DCI Lee's Summit - Rev. 3 01-16-20 - full set
01/17/2020 Plans PL2019401 - 2020-01-16 Planning Set
01/23/2020 Letter Applicant Letter - FDP (DFDP)
01/23/2020 Specifications DCI Lee's Summit - Mechanical Equipment Specifications
01/23/2020 A5-0
01/23/2020 A4-1
01/31/2020 FeeWorksheet
01/31/2020 Letter Applicant Letter - FDP (DFDP)
05/03/2020 20180111_2020-05-01 Pond Outlet Modification Letter
06/23/2020 20180111_2020-06-23 DRAINAGE DESIGN SUMMARY
07/08/2020 Plans 20180111_2020-06-29 Pond Outlet Controls Modification Letter

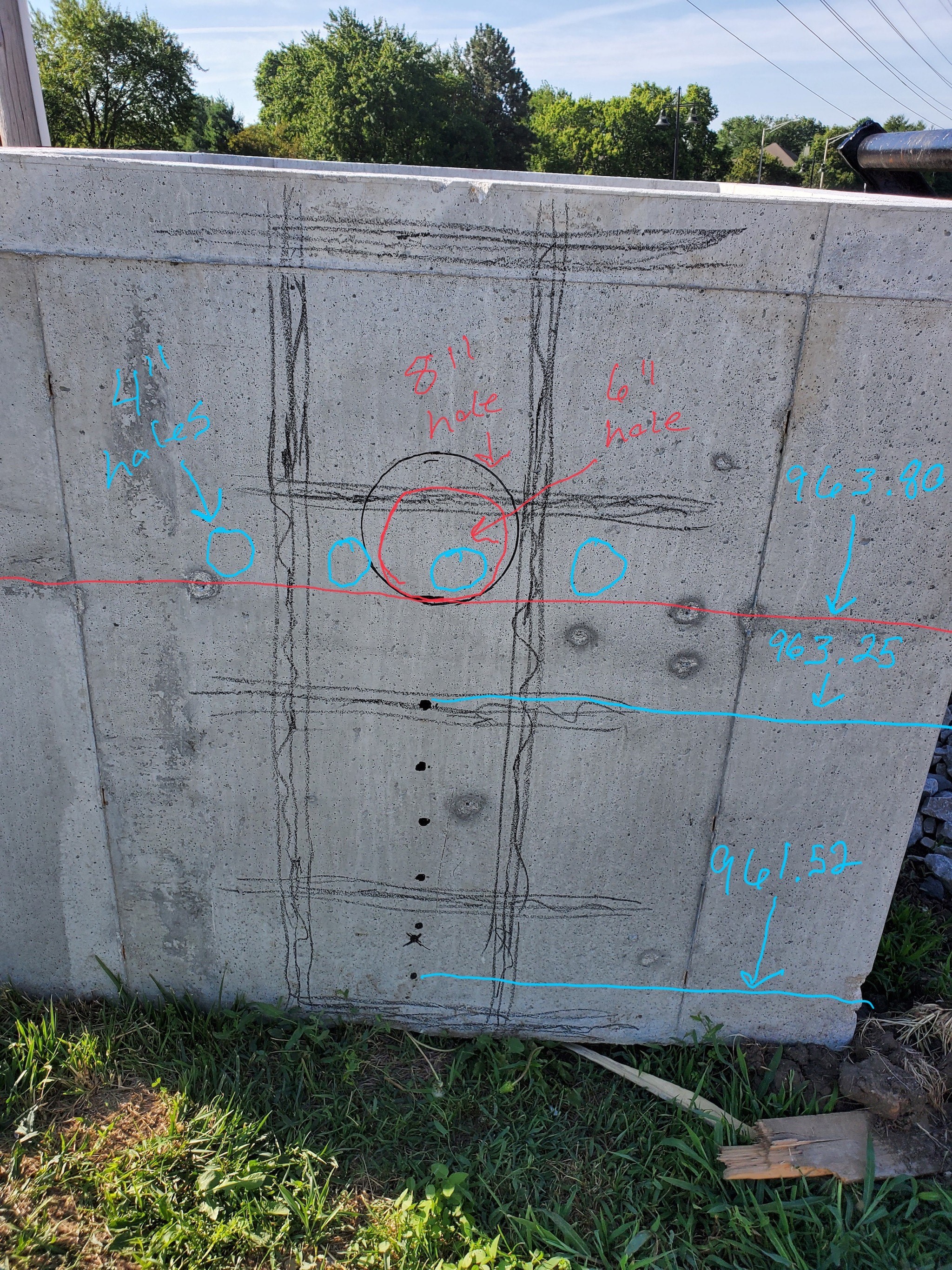

07/08/2020 Plans Pond outlet with X-rayed rebar in location of holes
07/08/2020 Plans 20180111_2020-06-29 DRAINAGE DESIGN SUMMARY
07/13/2020 Approved Plans Approved Revised Sheet C7.3 SITE DETAILS
08/13/2020 Specifications 20180111_2020-08-12 Data-Sheet-TENAX-LBO-302-CDG Reviewed
02/11/2021 Letter 20180111_2021-02-08 Record Summary Letter
02/11/2021 Plans 20180111_2021-02-08 Record Drawing and Calcs
02/18/2021 Email AS BUILT DETENTION COMMENTS
03/08/2021 Letter 20180111_2021-03-08 Response Letter
03/08/2021 Plans 20180111_2021-03-08 Record Drawings
03/08/2021 Engineer Report/Study 20180111_2021-03-08 Record Calcs
03/13/2021 Letter STKY AS BUILT DET COMMENTS MAR21
03/25/2021 Letter 20180111_2021-03-25 Response Letter
03/25/2021 Plans DETENTION ASBUILT ACCEPTED
03/25/2021 Engineer Report/Study 20180111_2021-03-25 Record Calcs
03/26/2021 ASBULT ACCEPTANCE EMAIL
03/26/2021 Approved Plans DCI Detention basin As-graded plan Accepted 3.26.21
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New license, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
