Summary

PRSUBD20211078
Public Infrastructure
Final Acceptance
OAK VIEW LEES SUMMIT LLC
DEVELOPMENT COMPLETE
PUBLIC SANITARY SEWER FOR LOT 5B AND TURN LANE FROM DOUGLAS ST
03/10/2021
04/08/2021
04/28/2022
Locations
Contacts
OAK VIEW LEES SUMMIT LLC, Address:201 HAWKS RIDGE TRL
ARC GENERAL CONTRACTING, Address:7833 BARTON ST, Phone:(913) 492-8008
LYLE GREENE, Address:ARC GENERAL CONTRACTING, Phone:(405) 747-5968
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 04/15/2021 07/06/2021
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $477.75 $477.75 Paid 03/18/2021
9110068-Storm Fee $222.75 $222.75 Paid 04/01/2021
9110081-Paved Surface Inspection Fee $1,814.70 $1,814.70 Paid 04/01/2021
9110071-Site Grading Fee $375.00 $375.00 Paid 04/01/2021
9110073-ROW Driveway Permit $80.00 $80.00 Paid 04/01/2021
9110080-Not Ready Inspection Fee $50.00 $50.00 Paid 11/11/2021
9110069-After Hours Inspections (Public Works)(Per Hour) $300.00 $300.00 Paid 11/11/2021
Outstanding Fees Amount Paid Owing Date Paid
9110080-Not Ready Inspection Fee $50.00 $0.00 $50.00 Not Paid

$50.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer - Air Test Passed 10/05/2021
Misc
Informational
10/05/2021
10/05/21 Tuesday Air Test passed the appropriate amount time required for 8” SDR - 26 .
Sanitary Sewer - Mandrel Passed 10/05/2021
Misc
Informational
10/05/2021
10//05/21 Tuesday (Breit Construction) Mandrel pass through 8” SDR-26 sewer pipe.
Sanitary Sewer - Vacuum Passed 10/05/2021
Misc
Informational
10/05/2021
10/05/21 Tuesday (Breit Construction) Vacuum pass by holding the 9psi for 2 minutes.
Erosion Control Inspection Passed 11/09/2021
Sanitary Sewer Construction Inspection Passed 11/09/2021
Misc
Informational
09/01/2021

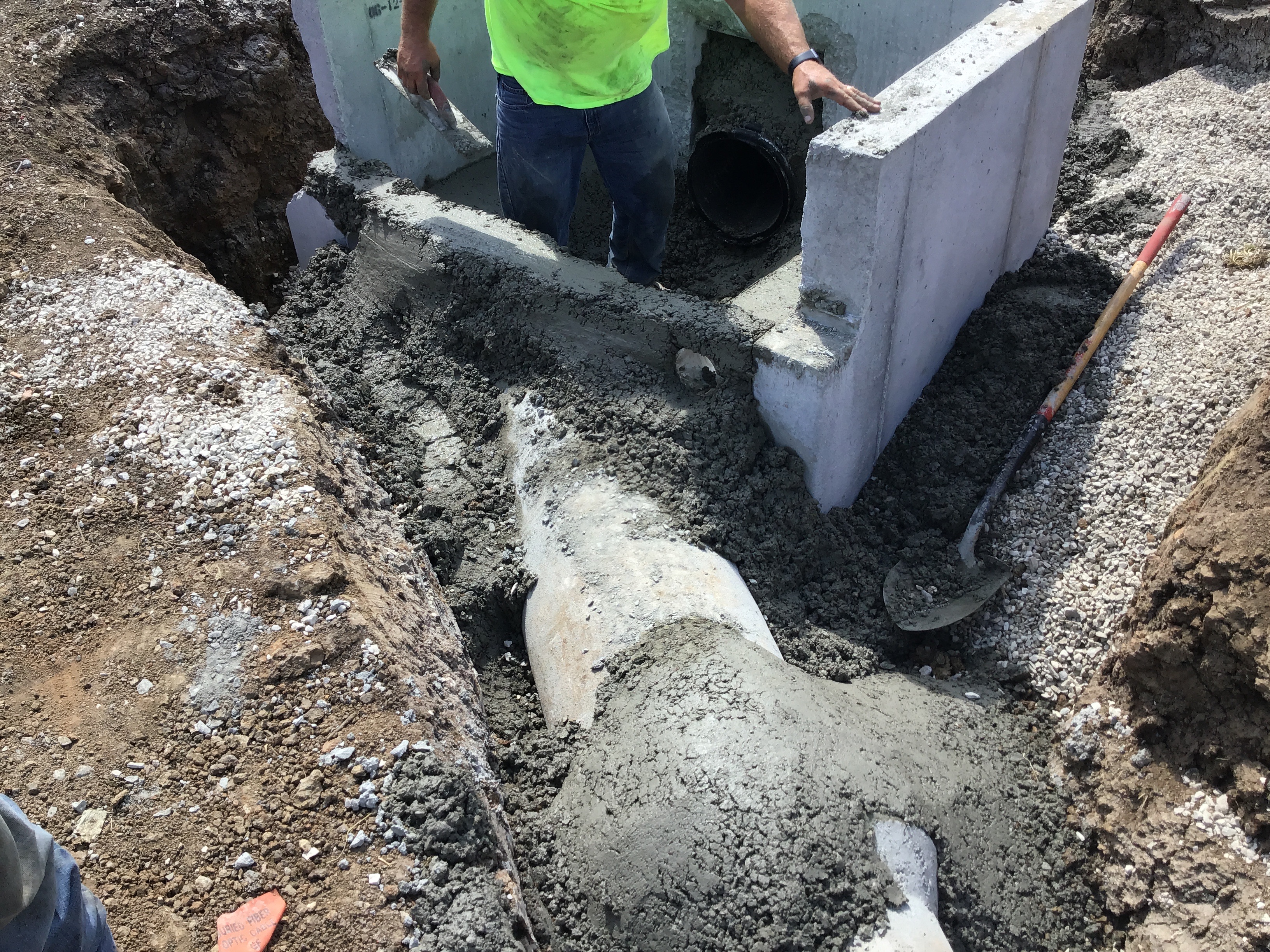

9/1/21 Wednesday Contractor installed 8” sanitary main approximately 41’ and MH (C-7). Existing 6” sanitary line was verified as a wye & 45 degree bend around existing MH (S). Existing 6” sanitary line was concrete and and the new 8” sanitary was installed over it. The newly installed 8” sanitary ran under the existing water line with 18” of clearance. KC Engineer testing third party for density test for street crossing of newly installed 8” sanitary line. 9/2/21 Tuesday Contractor poured invert & collars for MH . 10/29/21 Friday (Breit Const.) Contractor poured the invert for the existing MH because they bored into it for the extension as-per plan.
Grading/Excavation/Fill Inspection Passed 11/09/2021
Sanitary - Material Verification Passed 11/09/2021
Sanitary Sewer Construction Inspection Passed 11/09/2021
Pavement-Proof Roll Passed 11/09/2021
Misc
Informational
09/28/2021
9/28/21 Tuesday Proof roll of Turning Lane passed inspection. Third party inspection Kansas City Testing performed inspection. 10/19/21 Tuesday (Bash Const.) Proof roll of the Northside of Turning Lane & Drive Approach passed. Trucking Co. that performed proof roll Beyer Crushed Rock.
Pavement-Surface Passed 11/09/2021
Install Street and Stop Signs Passed 11/09/2021
Pavement-Aggregate Base Passed 11/09/2021
Pavement-Curb Construction Passed 11/09/2021
Misc
Informational
09/28/2021
9/28/21 Tuesday A.R.C. Lyle Subcontractor (Rockers Construction) poured curbs for Turning Lane. Third Party inspection (Kansas City Testing Lab) conducted required testing on concrete that was poured. 9/29/21 Wednesday A.R.C Lyle General Contractor Subcontractor (Rocker Construction) continued pour curb & Turning Lane.
Pavement-Stabilized Subgrade Passed 11/09/2021

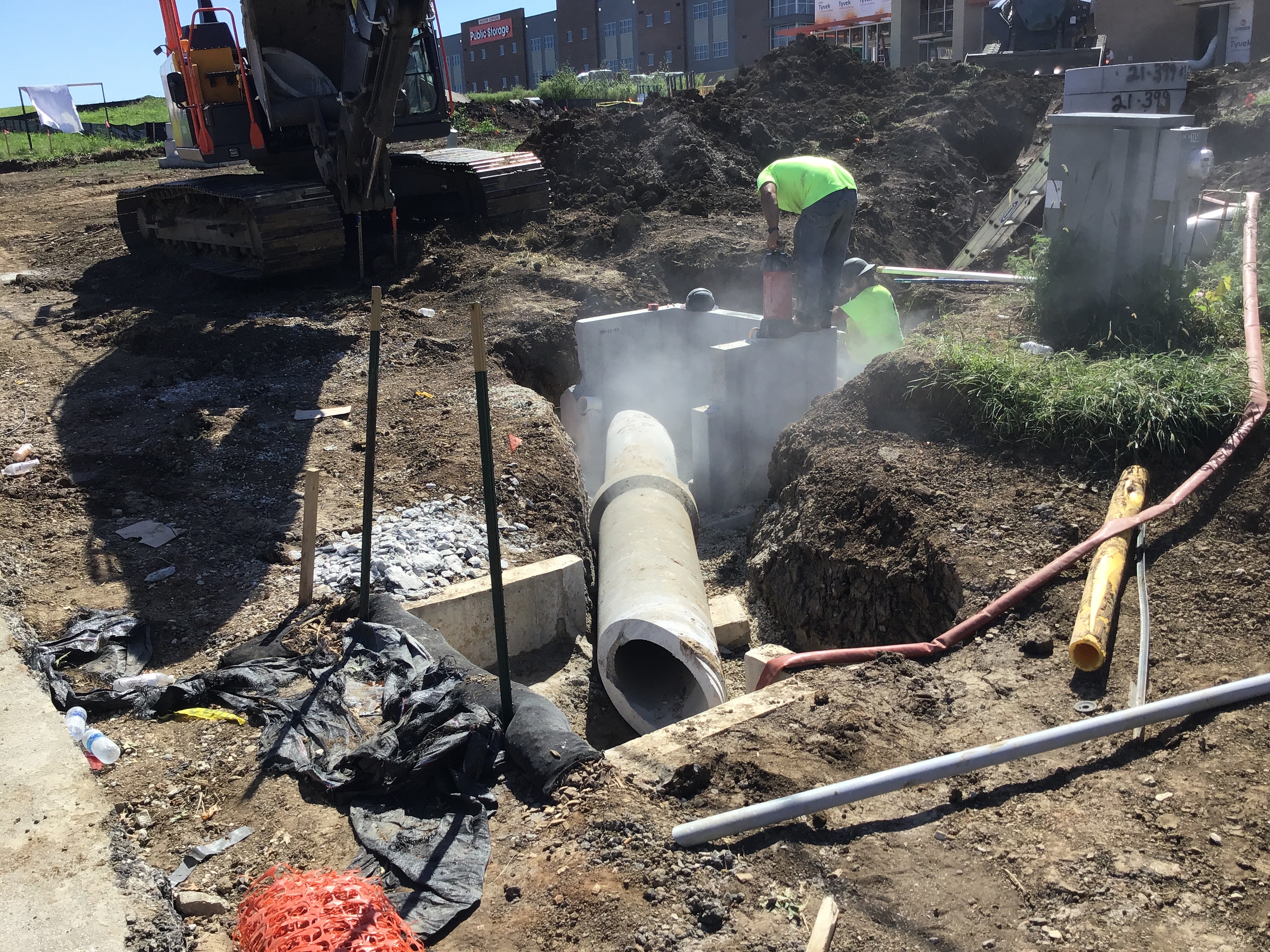

Storm Sewer Construction Inspection Passed 11/09/2021
Sanitary Sewer Construction Inspection Passed 11/09/2021
Sanitary Sewer Construction Inspection Passed 11/09/2021
Record Drawing Review Passed 11/5/2021 11/09/2021
Pavement-Aggregate Base Passed 11/09/2021
Pavement-Curb Construction Passed 11/09/2021
Pavement-Stabilized Subgrade Passed 11/09/2021
Misc
Informational
09/23/2021
9/23/21 Thursday Contractor has been working to stabilize turn lane with Geogrid and 6” of aggregate rock (AB-3). They faced numerous set backs due to weather, soil conditions, utilities and a bust in grading. We now at the point cleaning out the soft areas to add the proper depth of aggregate. Contractor should be ready for a roll test by Monday. 9/24/21 Friday Contractor continued to prepare Turning Lane for Proof Roll @ 9:00AM Monday.

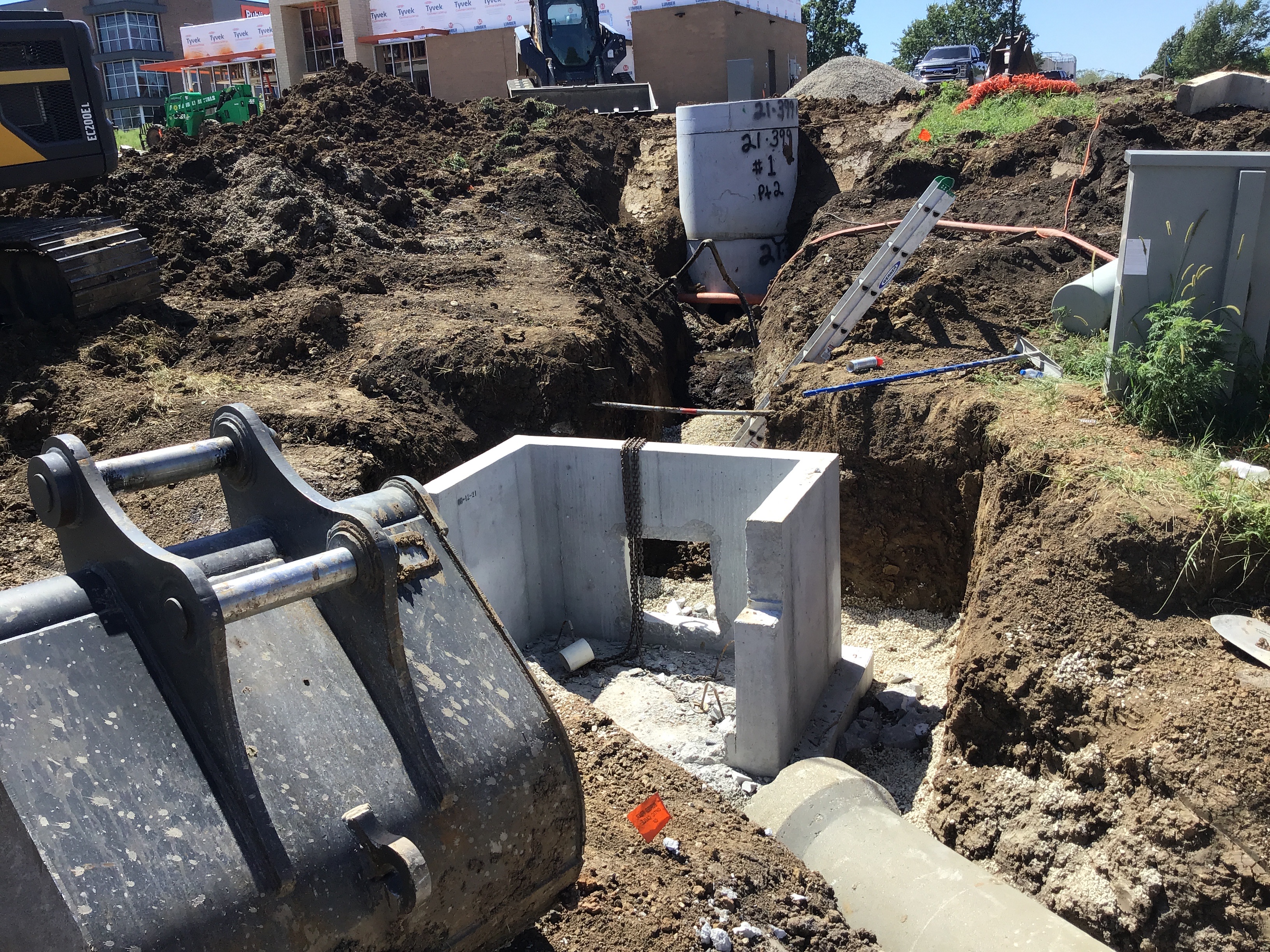

Storm Sewer Construction Inspection Passed 7/13/2021 11/09/2021
Misc
Informational
07/13/2021
They found the gas line in the way of the storm pipe. It will have to be removed. 8/19/21 Thursday Contractor installed approximately 120’ of 12” HDPE storm pipe from junction box 4 as per plan. Contractor has poured collars on all storm pipe that leads into storm boxes that were previously installed. 8/24/21 Tuesday Contractor had to make changes to fall in storm outlet do field condition. The fall has to be increased to avoid existing utilities ( see storm C 7.0). 15”RCP storm pipe is being adjust to fit converted inlet to junction box to newly installed inlet. 8/25/21 Wednesday Contractor poured collars & invert for modified junction box and newly installed inlet. 9/2/21 Thursday Contractor installIng CI that is along the driveway see C-6. The trench drain will not be installed and approved by City Engineer revision of plans was submitted. 9/7/21 Tuesday Contractor poured collars & invert on newly installed CI . 9/17/21 Friday Contractor completed roof drains approximately 2 weeks ago. 10/01/21 Friday (Breit Const.) Contractor is adjustIng Curb Inlet (CI) Lid along the driveway approximately 1’ high to better match grade of opposite drive. (This should lower the % of slope across future driveway).
Site Visit Complete 7/7/2021 7/7/2021 11/09/2021
Misc
Informational
07/07/2021
7-7-21 3:09pm Breit is on site digging out for the detention.
Site Visit Complete 7/8/2021 11/09/2021
Misc
Informational
07/07/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow.
Site Visit Complete 7/9/2021 7/9/2021 11/09/2021
Misc
Informational
07/08/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed.
Site Visit Complete 7/12/2021 11/09/2021
Misc
Informational
07/09/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions.
Site Visit Complete 7/13/2021 11/09/2021
Misc
Informational
07/12/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-13-21 10:30am There is a gas line in the way of the storm line that needs to be ran from the site to the existing box on Douglas. There is a utility box in the way of the drive that they are calling locates on. 2pm I met with Andy Breit on site to go over the detention. It will neeed to move to make room for the wall.
Site Visit Complete 7/20/2021 11/09/2021
Misc
Informational
07/13/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-13-21 10:30am There is a gas line in the way of the storm line that needs to be ran from the site to the existing box on Douglas. There is a utility box in the way of the drive that they are calling locates on. 2pm I met with Andy Breit on site to go over the detention. It will neeed to move to make room for the wall. 7-20-21 8:38am They have the turn lane cut out. They are waiting on locates for a utility box in the drive. They are on hold for the detention due to a conflict with the retaining wall.
Site Visit Complete 7/14/2021 7/14/2021 11/09/2021
Misc
Informational
07/14/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place.
Site Visit Complete 7/21/2021 7/21/2021 11/09/2021
Misc
Informational
07/20/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box.
Site Visit Complete 7/23/2021 11/09/2021
Misc
Informational
07/21/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved.
Site Visit Complete 7/26/2021 11/09/2021
Misc
Informational
07/23/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved.
Site Visit Complete 7/27/2021 11/09/2021
Misc
Informational
07/26/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections.
Site Visit Complete 7/28/2021 7/28/2021 11/09/2021
Misc
Informational
07/27/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time.
Site Visit Complete 7/29/2021 11/09/2021
Misc
Informational
07/28/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time.
Site Visit Complete 11/09/2021
Misc
Informational
07/29/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today.
Site Visit Complete 8/3/2021 11/09/2021
Misc
Informational
07/30/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building.
Water Line - Construction Inspection Passed 8/2/2021 8/2/2021 11/09/2021
Misc
Informational
08/02/2021
8-2-21 11:06am Breit is on site digging out for the water line. They will be getting there taps tomorrow.
Water Line - Construction Inspection Passed 11/09/2021
Misc
Informational
08/02/2021
8-2-21 11:06am Breit is on site digging out for the water line. They will be getting there taps tomorrow.
Site Visit Complete 8/4/2021 8/4/2021 11/09/2021
Misc
Informational
08/03/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time.
Site Visit Complete 8/5/2021 8/5/2021 11/09/2021
Misc
Informational
08/04/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time.
Site Visit Complete 8/5/2021 8/5/2021 11/09/2021
Misc
Informational
08/05/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th.
Site Visit Complete 8/6/2021 11/09/2021
Misc
Informational
08/05/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th. 8-6-21 9:24am Breit is on site installing the new liner for the detention.
Site Visit Complete 8/9/2021 11/09/2021
Misc
Informational
08/06/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th. 8-6-21 9:24am Breit is on site installing the new liner for the detention. 8-9-21 9am Breit is on site working on the detention system. They have punctured a hole in the liner and are making a patch repair.
Site Visit Complete 8/10/2021 11/09/2021
Misc
Informational
08/09/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th. 8-6-21 9:24am Breit is on site installing the new liner for the detention. 8-9-21 9am Breit is on site working on the detention system. They have punctured a hole in the liner and are making a patch repair. 8-10-21 9:26am Rain. There is no work taking placce.
Site Visit Complete 8/11/2021 11/09/2021
Misc
Informational
08/10/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th. 8-6-21 9:24am Breit is on site installing the new liner for the detention. 8-9-21 9am Breit is on site working on the detention system. They have punctured a hole in the liner and are making a patch repair. 8-10-21 9:26am Rain. There is no work taking place. 8-11-21 10:37am full sun. Breit is on site working on the detention. 2:56pm They have approximately 60 percent covered on the detention. 9/20/21 Monday I met with site superintendent about the raising the vault lid of an existing Backflow Preventer to meet grade of sidewalk and parking lot. 10/14/21 Thursday Met with Lyle about the the proof roll of turning lane after regrading and rainy weather conditions.
Site Visit Complete 11/09/2021
Misc
Informational
08/11/2021
7-7-21 3:09pm Breit is on site digging out for the detention. 7-8-21 1:30pm Breit is on site digging out for the detention. They will be done with the digging today and start laying fabric and rock tomorrow. 7-9-21 10:23am Breit has installed the fabric in the detention hole and are laying rock now. They have the storm boxes placed. 7-12-21 2:30pm I talked with the contractor on site about the turn lane on Douglas and utilities. I have spoke with Sue about the issues and have found the solutions. 7-14-21 11:16am No inspections are needed. There is not site work taking place. 7-21-21 9:19am I met Bob Burns and Scott Koch on site to confirm the utilities box is dead. The contractor can remove the box. 7-22-21 2:15pm Breit Construction were working on the detention without approved plans or a third party inspector. I informed them that they are working at there own risk and no other work will take place on site until there is a re-submitted plan that is approved. The GC for Whataburger is not on site. 7-23-21 2pm I met Lyle the superintendent on site to look at sidewalk placement. They want to go around the ATT boxes to avoid adjusting them. Sue Pyles and I agree the adjustment can be achieved. 7-26-21 1:05pm ARC are working on digging out for the turn lane. The utility box in the drive has been moved. 7-27-21 8:28am There is no work taking place a this time that requires inspections. 7-28-21 10:51am I talked to Andy Breit and Lyle on site about the detention and water tap. Nothing can be done at this time. 7-29-21 1:54pm The work taking place does not require any inspections from me at this time. 7-30-21 1:23pm I spoke with Lyle the superintendent. There is no work taking place that will require inspections from me today. 8-3-21 9:18am The water department is on site to tap the main for domestic to the building. 8-4-21 10:19am The work taking place on site does not require inspections from me at this time. 8-5-21 8:29am There is no work taking place at this time. 12:49pm Breit is on site working on the detention. They will have a new liner to install tomorrow the 6th. 8-6-21 9:24am Breit is on site installing the new liner for the detention. 8-9-21 9am Breit is on site working on the detention system. They have punctured a hole in the liner and are making a patch repair. 8-10-21 9:26am Rain. There is no work taking place. 8-11-21 10:37am full sun. Breit is on site working on the detention. 2:56pm They have approximately 60 percent covered on the detention.
Pavement-Proof Roll Passed 11/09/2021
Misc
Informational

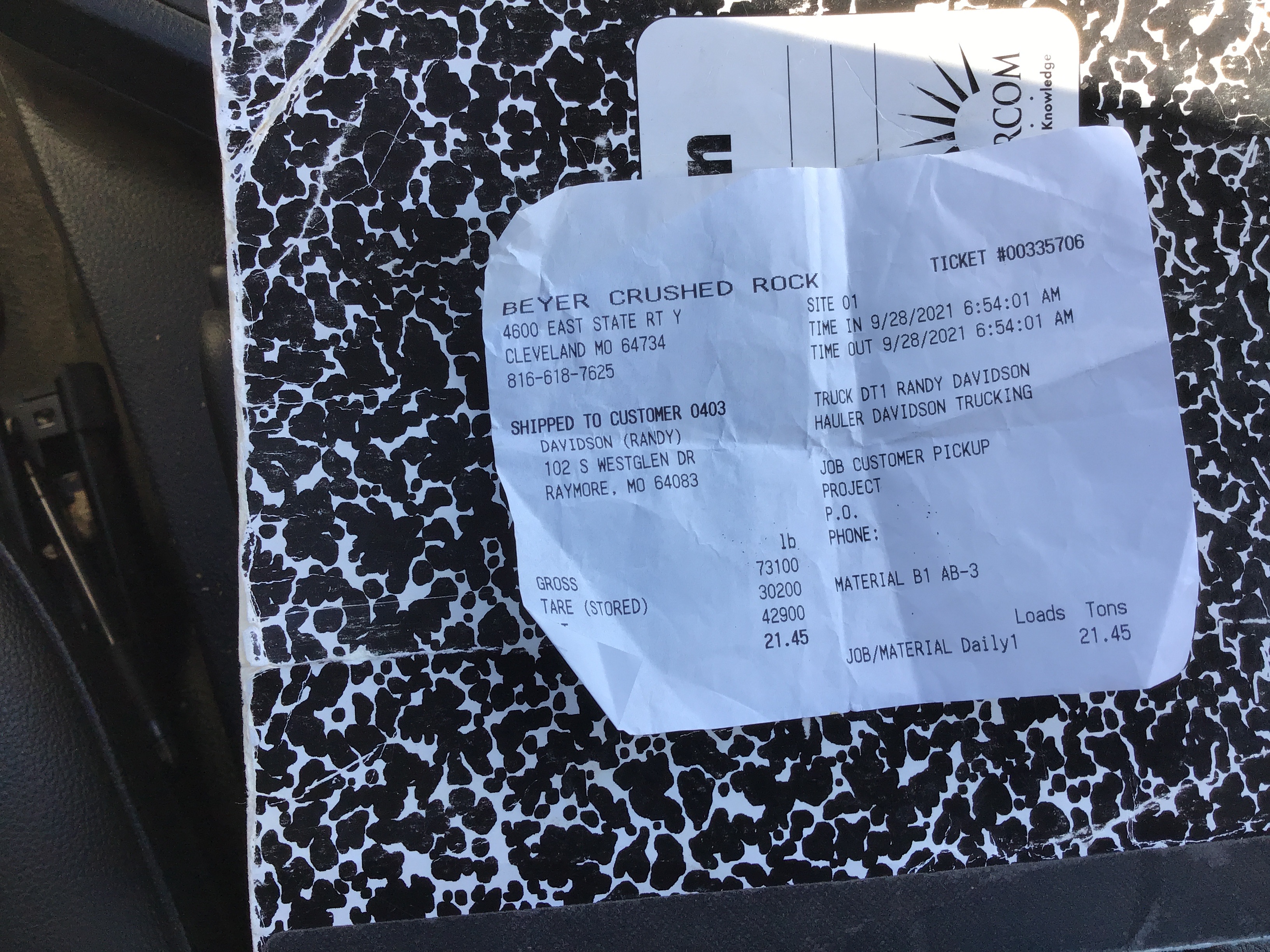

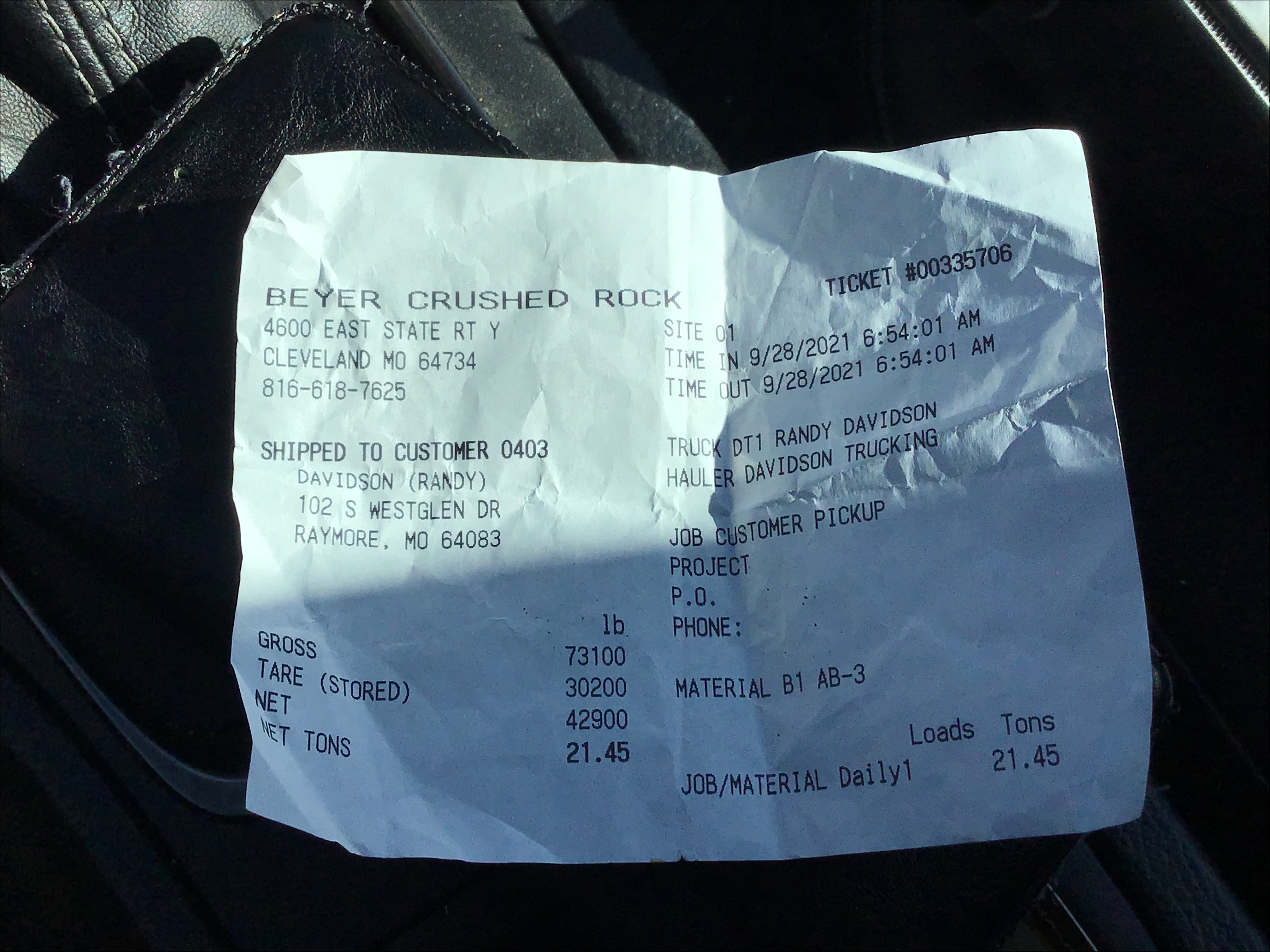

09/28/2021

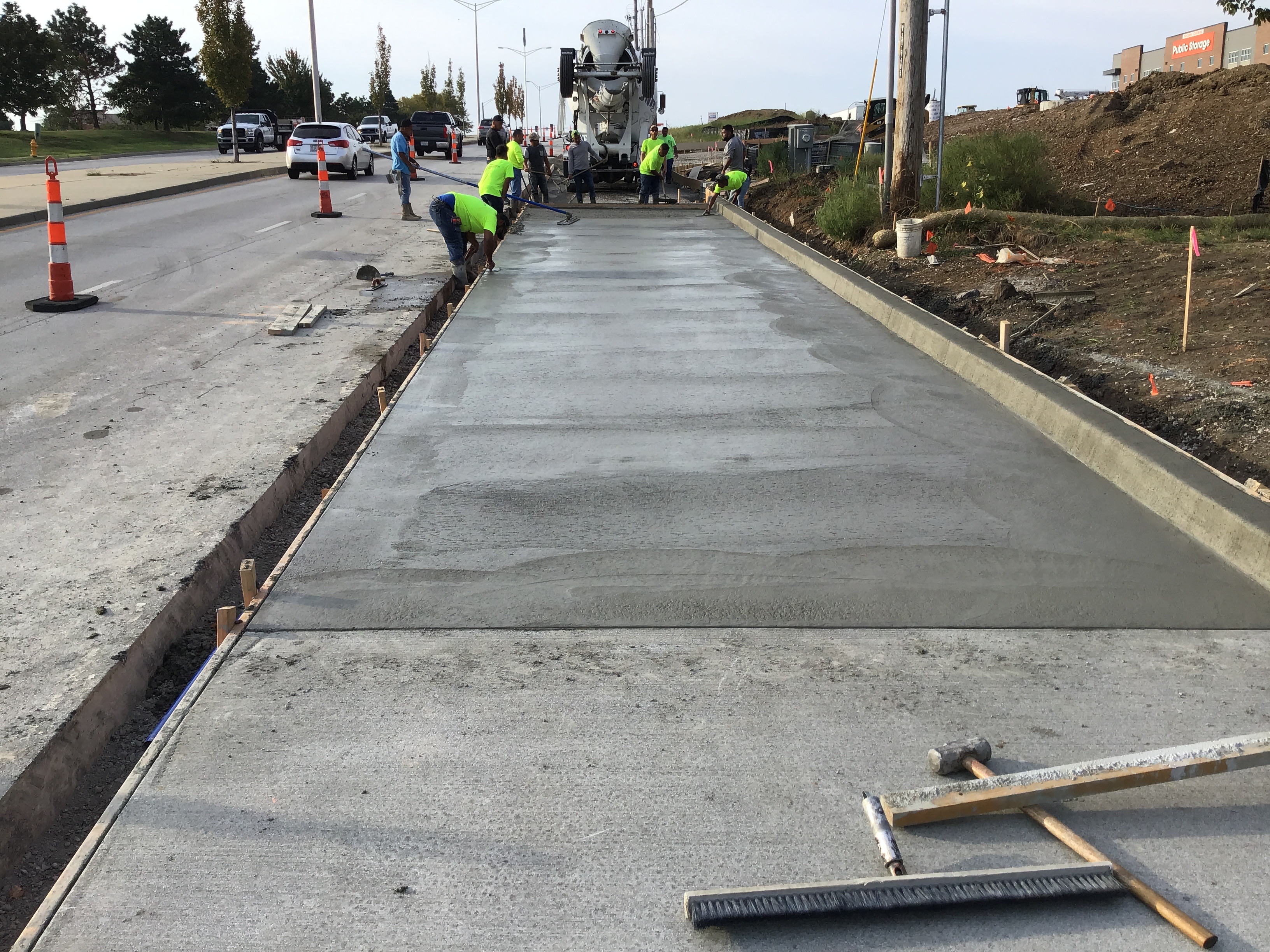

9/28/21 Tuesday Proof roll of Turning Lane passed inspection. Third party inspection Kansas City Testing performed inspection.
Sanitary Sewer - Air Test Passed 11/09/2021
Sanitary Sewer - Mandrel Passed 11/09/2021
Sanitary Sewer - Vacuum Passed 11/09/2021
Pavement-Surface Passed 11/09/2021
Misc
Informational

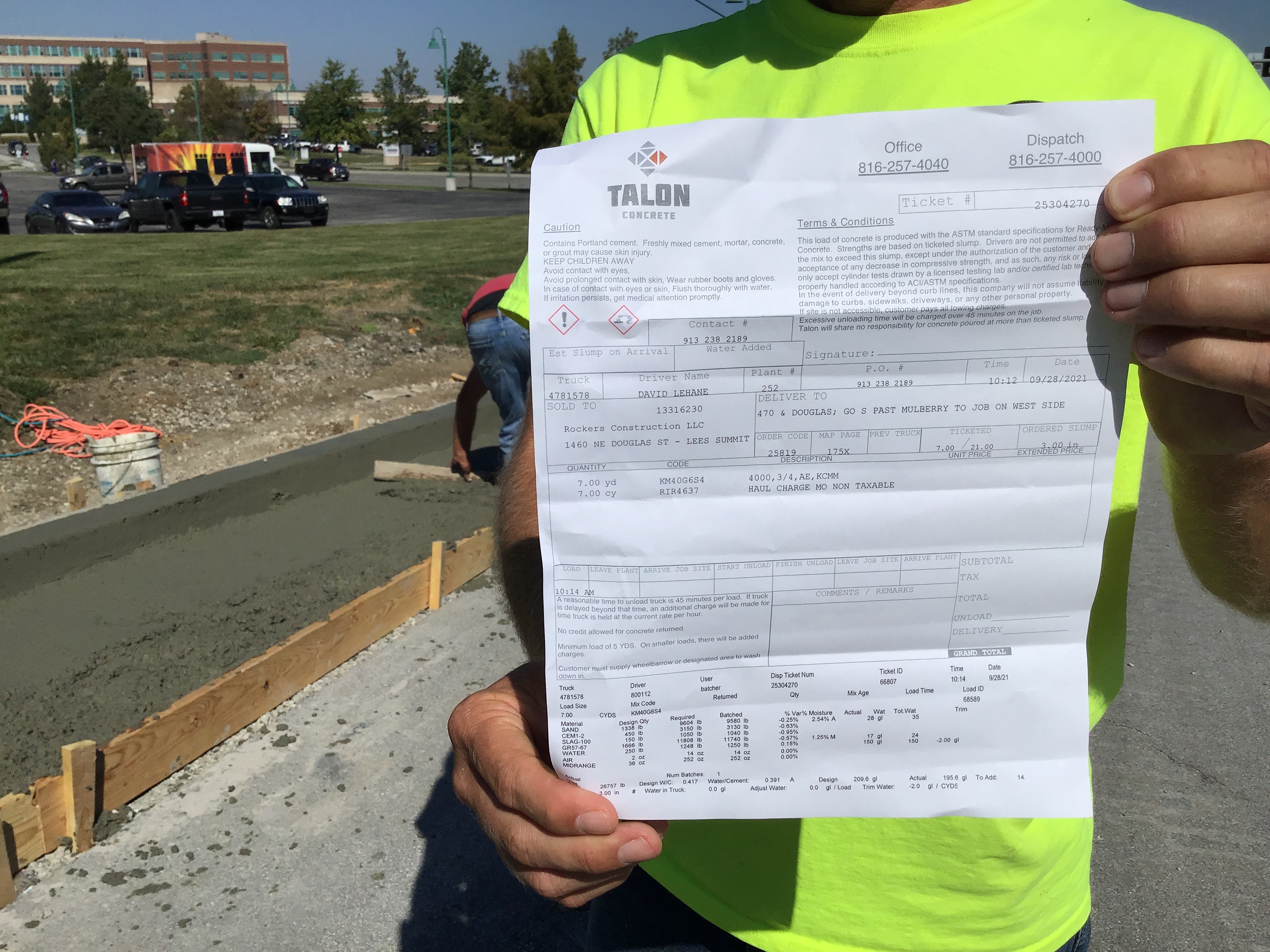

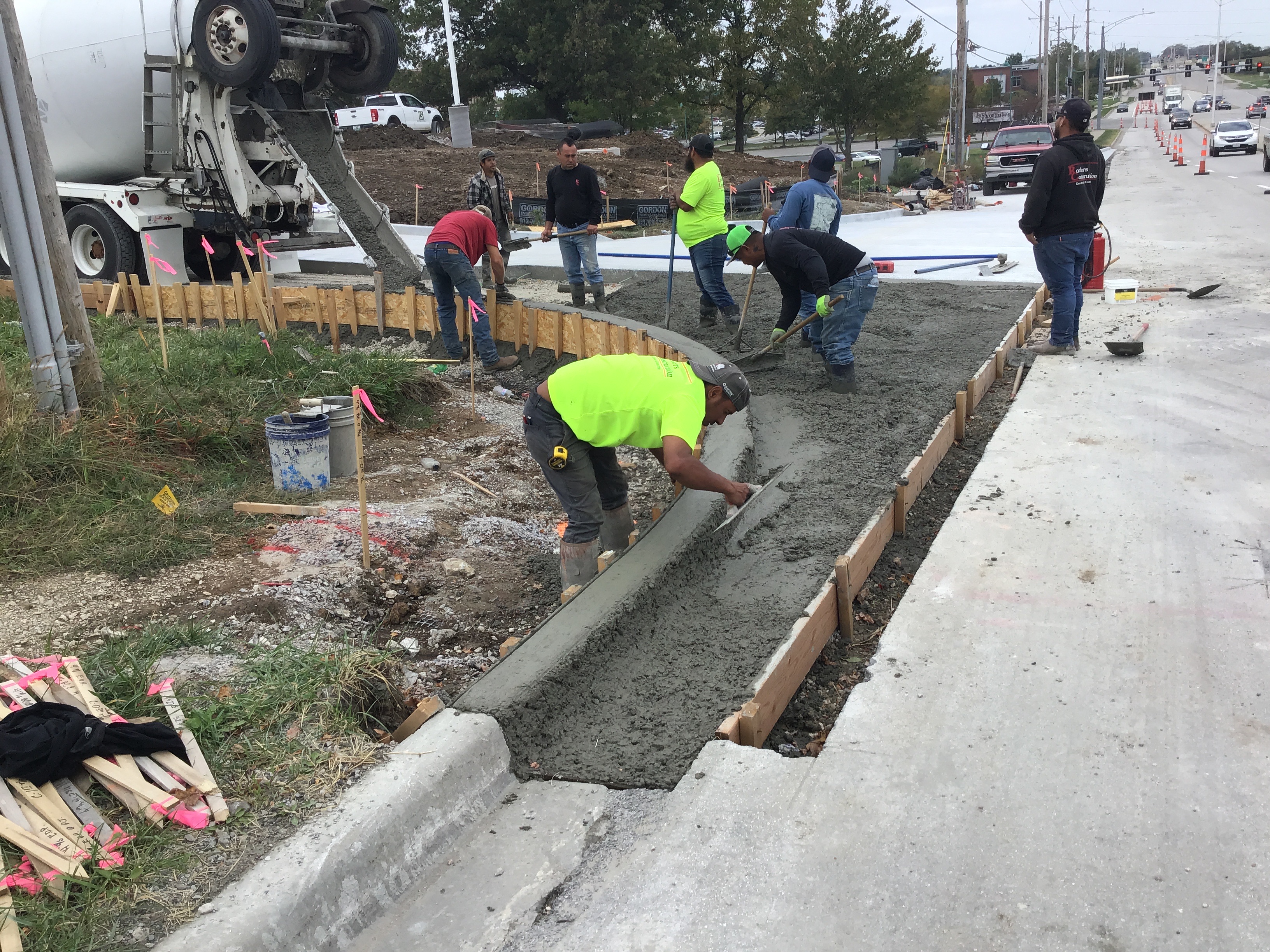

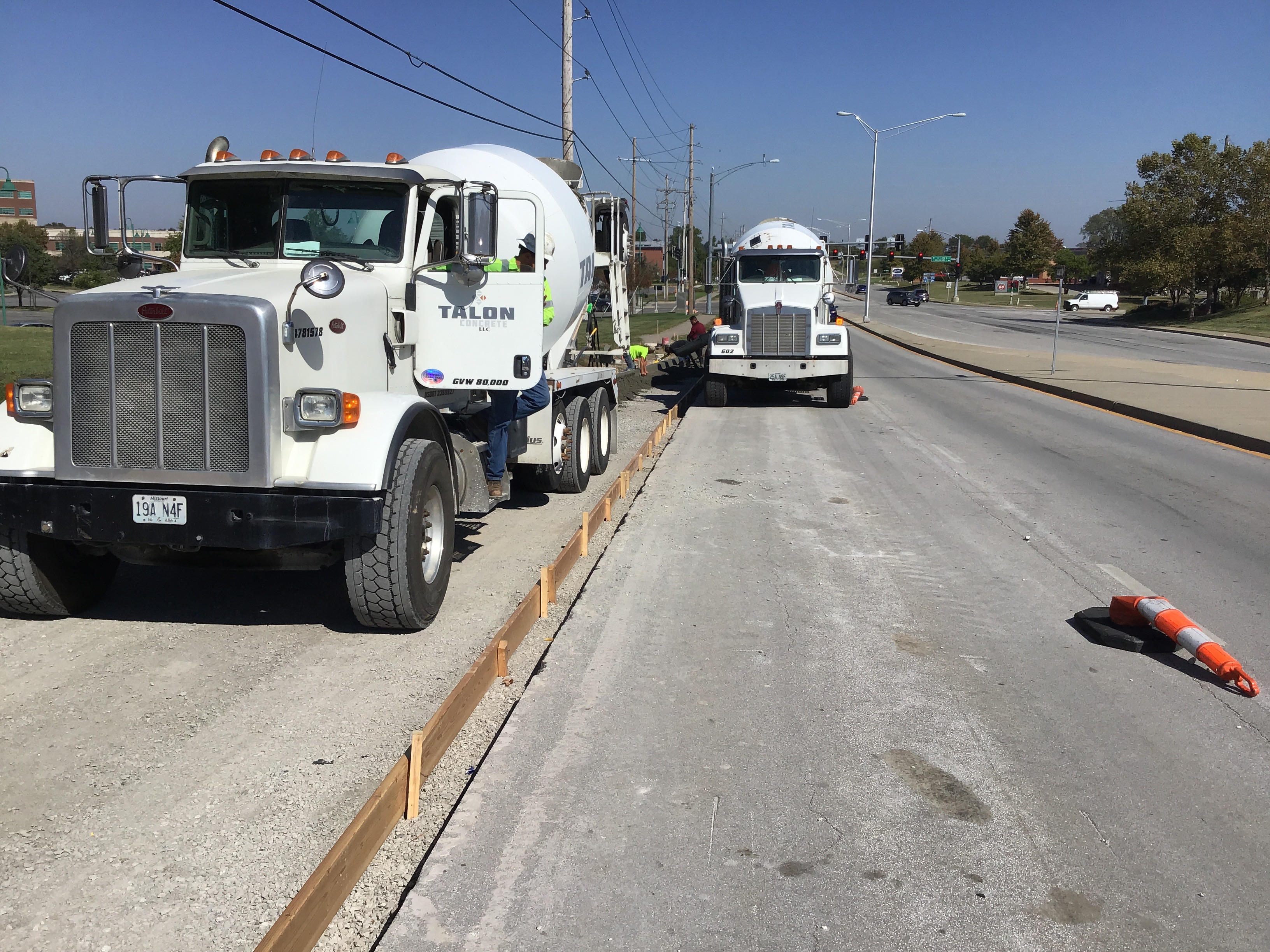

10/08/2021

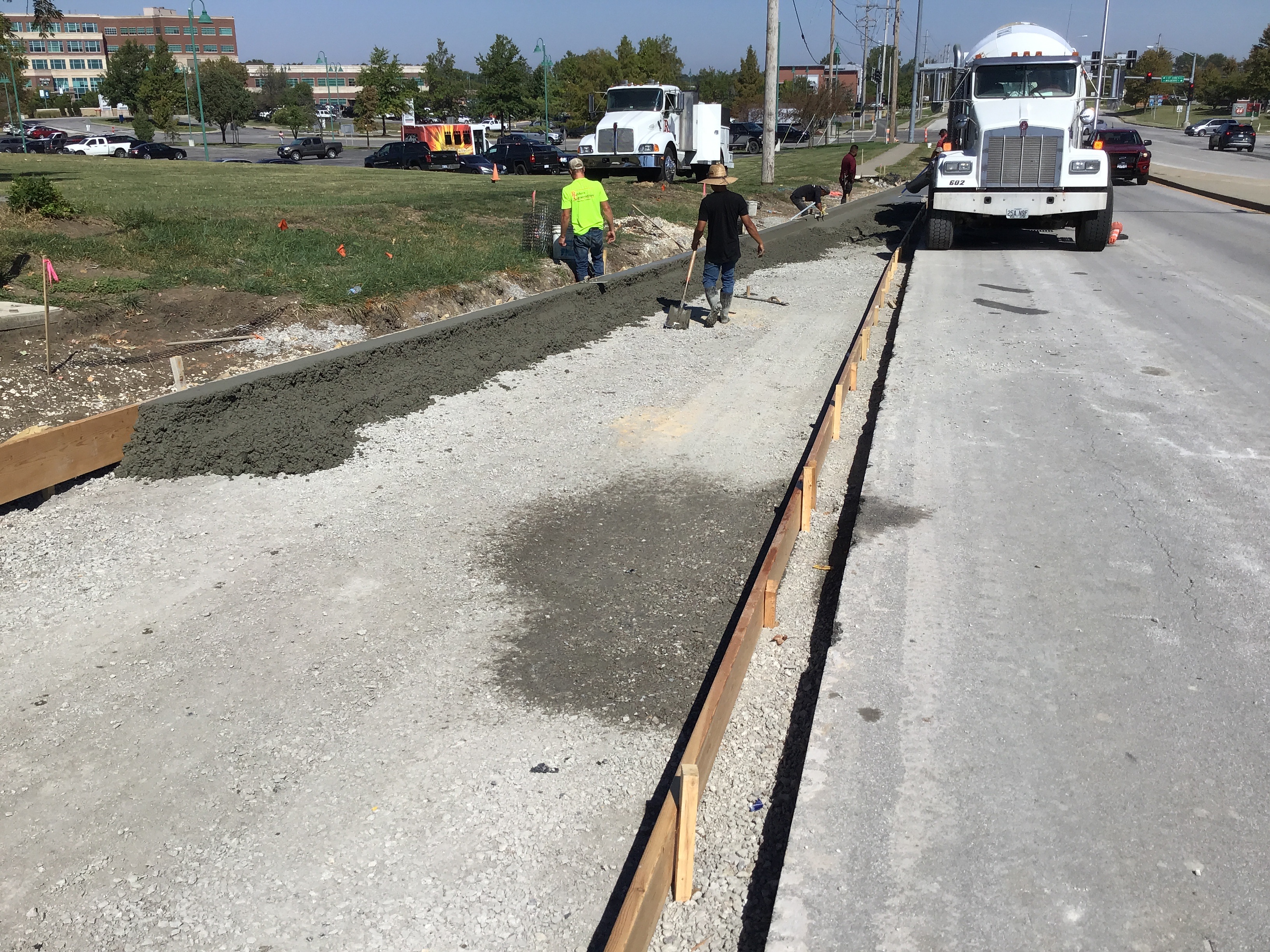

10/08/21 Friday (ACR Const.) Contractor continued to pour curb lane, concrete was cured and saw cut. Contractor had to stop work on Approach Drive due to the wetness of AB3. Contractor will contact me when area has dry enough for a proof roll. 10/19/21 Tuesday (ACR Const. General) - (Rockers Const.) Contractor poured half the approach on the Northside. 10/20/21 Wednesday (Rockers Const.) Contractor poured the Southside of approach. The 10” Wide connecting joint with NE Douglas St. will be poured tentatively set for tomorrow. Contractor will begin excavation of 14” wide connecting joint to a 10” depth, 8” of concrete can be poured and a 3’ wide & 2” deep asphalt overlay can laid. 10/21/21 Thursday (Rockers Const.) Contractor poured 8” depth & 14” wide fillet that connects the concrete portion of turning and approach to the asphalt street NE Douglas Street. Work completed @ 4:45PM.
Sidewalk Inspection Passed 11/09/2021
Misc
Informational
11/02/2021

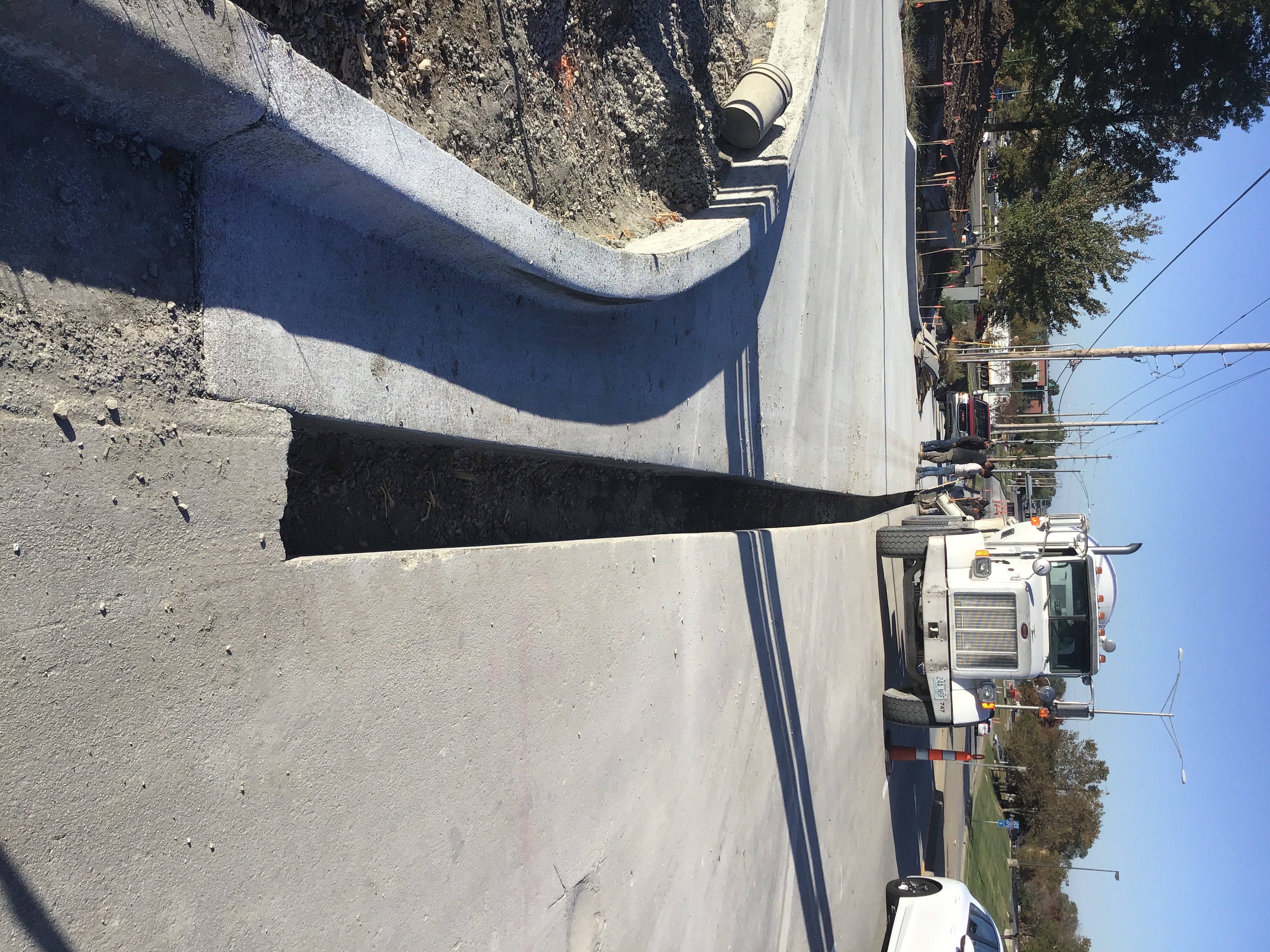

11/2/21 Tuesday Contractor poured sidewalks & ADA ramp as-per plan.
Sanitary Sewer - Air Test Passed 11/09/2021
Sanitary Sewer - Mandrel Passed 11/09/2021
Sanitary Sewer - Vacuum Passed 11/09/2021
Sanitary Sewer - Air Test Passed 11/09/2021
Sanitary Sewer - Camera Test Partial 12/16/2021 11/23/2021
Misc
Corrective Action Required
11/23/2021
Need to have water dept. verify that punch list item are all good.
ESC - (Vegetation/Ground Cover) Not Ready 06/17/2022
Documents & Images
Date Uploaded File Type Document Name
03/18/2021 Receipt Receipt for transaction:2021-001393
04/01/2021 Receipt Receipt for transaction:2021-001695
04/05/2021 Approved Plans Whataburger Deceleration Lane Approved 4.5.21
04/05/2021 Approved Plans Oakview Storage, Lot 5 Sanitary Approved 4.5.21
07/07/2021 Letter INSPECTION SUMMARY
07/08/2021 Letter INSPECTION SUMMARY
07/09/2021 Letter INSPECTION SUMMARY
07/12/2021 Letter INSPECTION SUMMARY
07/13/2021 Letter INSPECTION SUMMARY
07/13/2021 Letter INSPECTION SUMMARY
07/14/2021 Letter INSPECTION SUMMARY
07/14/2021 Letter INSPECTION SUMMARY
07/14/2021 Letter INSPECTION SUMMARY
07/20/2021 Letter INSPECTION SUMMARY
07/21/2021 Letter INSPECTION SUMMARY
07/22/2021 Detention .jpg
07/23/2021 Letter INSPECTION SUMMARY
07/26/2021 Letter INSPECTION SUMMARY
07/27/2021 Letter INSPECTION SUMMARY
07/28/2021 Letter INSPECTION SUMMARY
07/29/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
08/02/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/04/2021 Letter INSPECTION SUMMARY
08/05/2021 Letter INSPECTION SUMMARY
08/05/2021 Letter INSPECTION SUMMARY
08/06/2021 Letter INSPECTION SUMMARY

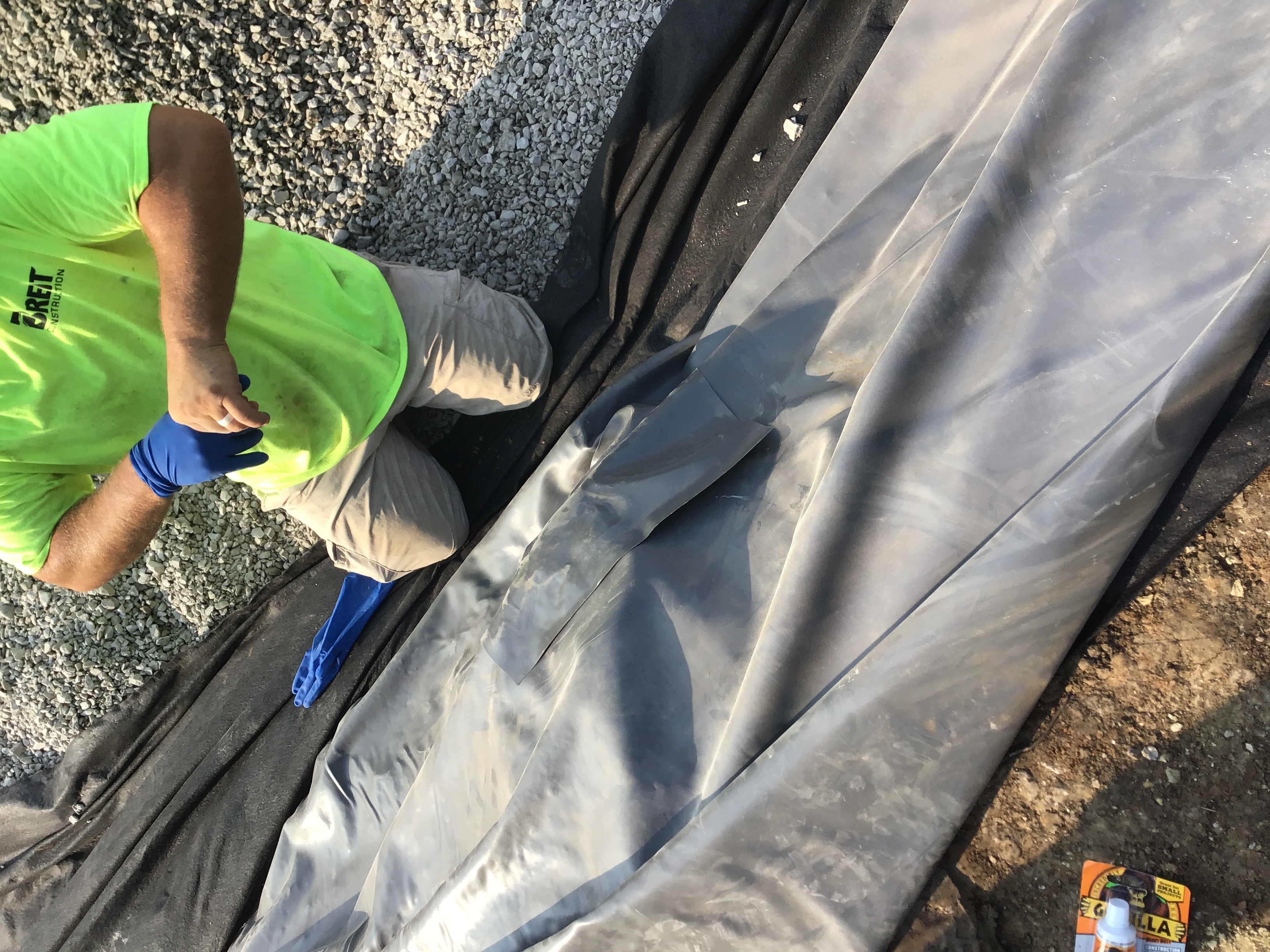

08/09/2021 Detention .jpg0
08/09/2021 Detention 2.jpg
08/09/2021 Detention 3.jpg
08/09/2021 Patch on the liner.jpg
08/09/2021 Letter INSPECTION SUMMARY
08/10/2021 Letter INSPECTION SUMMARY
08/11/2021 Letter INSPECTION SUMMARY

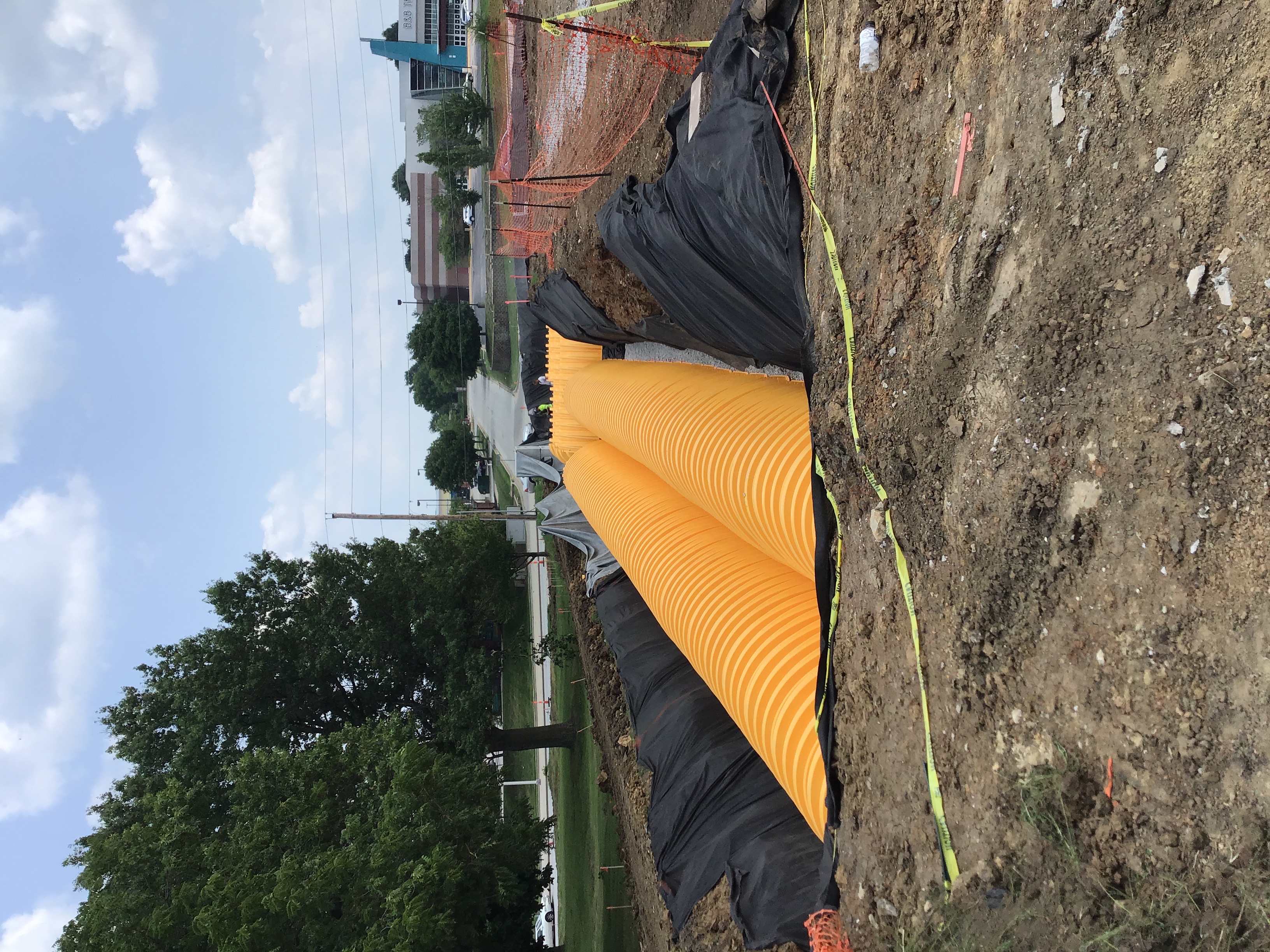

08/24/2021 image.jpg
08/24/2021 image.jpg0
08/24/2021 image.jpg1
08/24/2021 image.jpg2
08/25/2021 image.jpg3
09/01/2021 Letter INSPECTION SUMMARY
09/01/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
09/20/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/24/2021 Letter INSPECTION SUMMARY
09/28/2021 image.jpg4
09/28/2021 image.jpg5
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 image.jpg6
09/28/2021 image.jpg7
09/28/2021 image.jpg8
09/29/2021 image.jpg9
09/29/2021 image.jpg10
10/01/2021 Letter INSPECTION SUMMARY
10/01/2021 Letter INSPECTION SUMMARY
10/01/2021 Letter INSPECTION SUMMARY

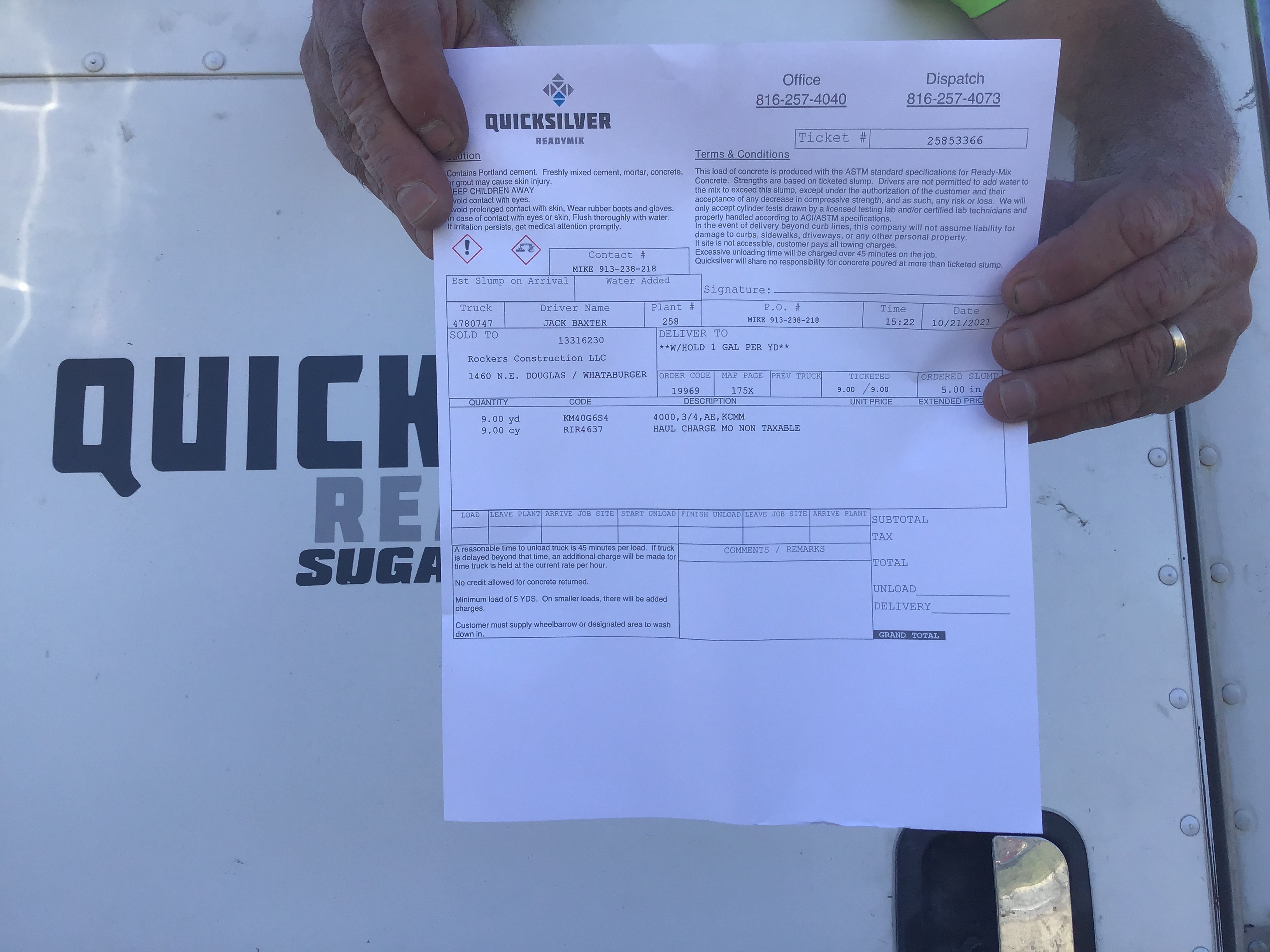

10/05/2021 Letter INSPECTION SUMMARY
10/05/2021 Letter INSPECTION SUMMARY
10/05/2021 Letter INSPECTION SUMMARY
10/05/2021 Letter INSPECTION SUMMARY
10/06/2021 Approved Plans Whataburger Revised Public Plans - Decel Turn Lane Approved 10.6.21
10/08/2021 Letter INSPECTION SUMMARY

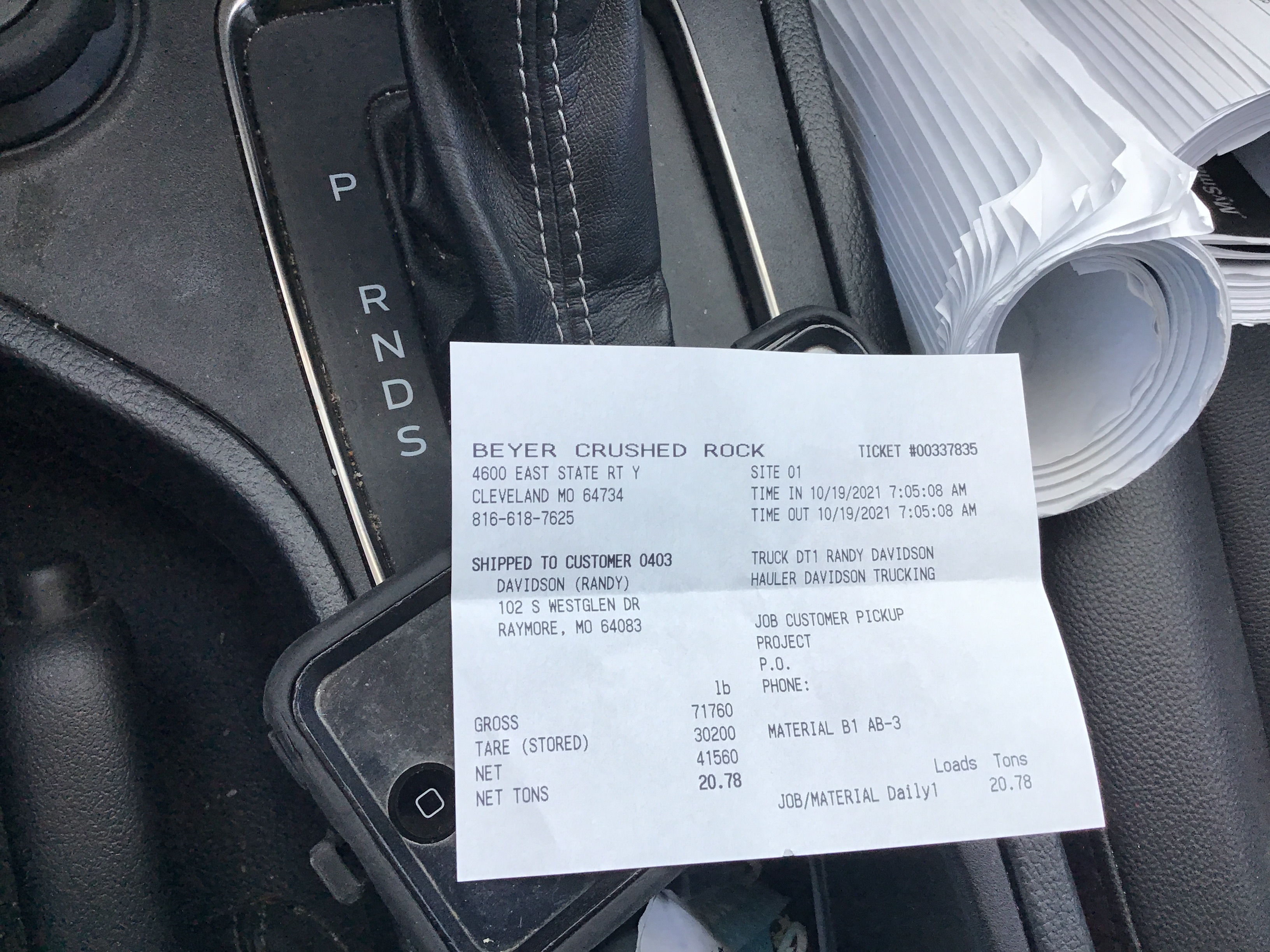

10/19/2021 image.jpg11
10/19/2021 Letter INSPECTION SUMMARY
10/20/2021 Letter INSPECTION SUMMARY
10/20/2021 image.jpg12
10/20/2021 image.jpg13
10/21/2021 image.jpg14
10/21/2021 image.jpg15
11/01/2021 Plans Whataburger Deceleration Lane As-Builts

11/11/2021 Receipt Receipt for transaction:2021-008700
11/23/2021 Letter INSPECTION SUMMARY
11/23/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
11/24/2021 Letter DE-Punch List
12/13/2021 Security Document Whataburger Maintenance Bond
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
04/28/2022 Activity Document affidavit
04/28/2022 Letter DE-Certificate of Final Acceptance (Commercial)
04/28/2022 Whataburger Off-Site Public Infrastructure Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
