Permit Application Status

PRSUBD20203599


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20203599
Public Infrastructure
Final Acceptance
WHISPERING WOODS LAND LLC
DEVELOPMENT COMPLETE
Full infrustructure development for final plat
10/08/2020
12/02/2020
08/07/2023
Locations
Contacts
WHISPERING WOODS LAND LLC, Address:803 PCA ROAD
REDFORD CONSTRUCTION INC, Address:PO BOX 1065, Phone:(816) 540-2030
ROBBINS KAREN, Address:1509 SW 27TH ST
RICKY & LINDA KING TRUST DATED 12/21/2021, Address:1601 SW 27TH ST
KERBER LOURIE S & THOMAS J, Address:265 LEMONWOOD LN
BURAU PAIGE & AUSTIN, Address:1609 SW 27TH ST
BARG SAMUEL A & AMY L, Address:1613 SW 27TH ST
SCHLOSSER JEREMY & KRISTIN, Address:1617 SW 27TH ST
GUNTER GARTH & DAWNA, Address:1621 SW 27TH ST
FOX MICHAEL & KIRSTIN, Address:1701 SW 27TH ST
COLEMAN BRANDON & STEPHANIE, Address:1705 SW 27TH ST
D AND D BUILDING INC, Address:1100 NE DELTA SCHOOL RD
HOLLIS JACOB B, Address:1604 SW 27TH ST
FISCHER ADAM B, Address:906 THOMPSON BLVD
STRECK WILLIAM P & HALEY L, Address:1612 SW 27TH ST
D&D BUILDING INC, Address:1100 NE DELTA SCHOOL RD
DASILVA PEREZ ALBERTO R & KERKHOFF PEREZ JULIANE, Address:1620 SW 27TH ST
UTZ HAYLEY R, Address:1624 SW 27TH ST
JARNEVIC LIVING TRUST DATED 9-7-2011 AMEND 11-27-2018, Address:1700 SW 27TH ST
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 10/08/2020 12/02/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $2,199.30 $2,199.30 Paid 12/01/2020
91100C9-Water Insp Fee $2,019.03 $2,019.03 Paid 12/01/2020
9110072-Water Test Fee $400.00 $400.00 Paid 12/01/2020
9110068-Storm Fee $3,912.30 $3,912.30 Paid 12/01/2020
9110081-Paved Surface Inspection Fee $8,799.45 $8,799.45 Paid 12/01/2020
9110071-Site Grading Fee $3,034.50 $3,034.50 Paid 12/01/2020
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 12/01/2020
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

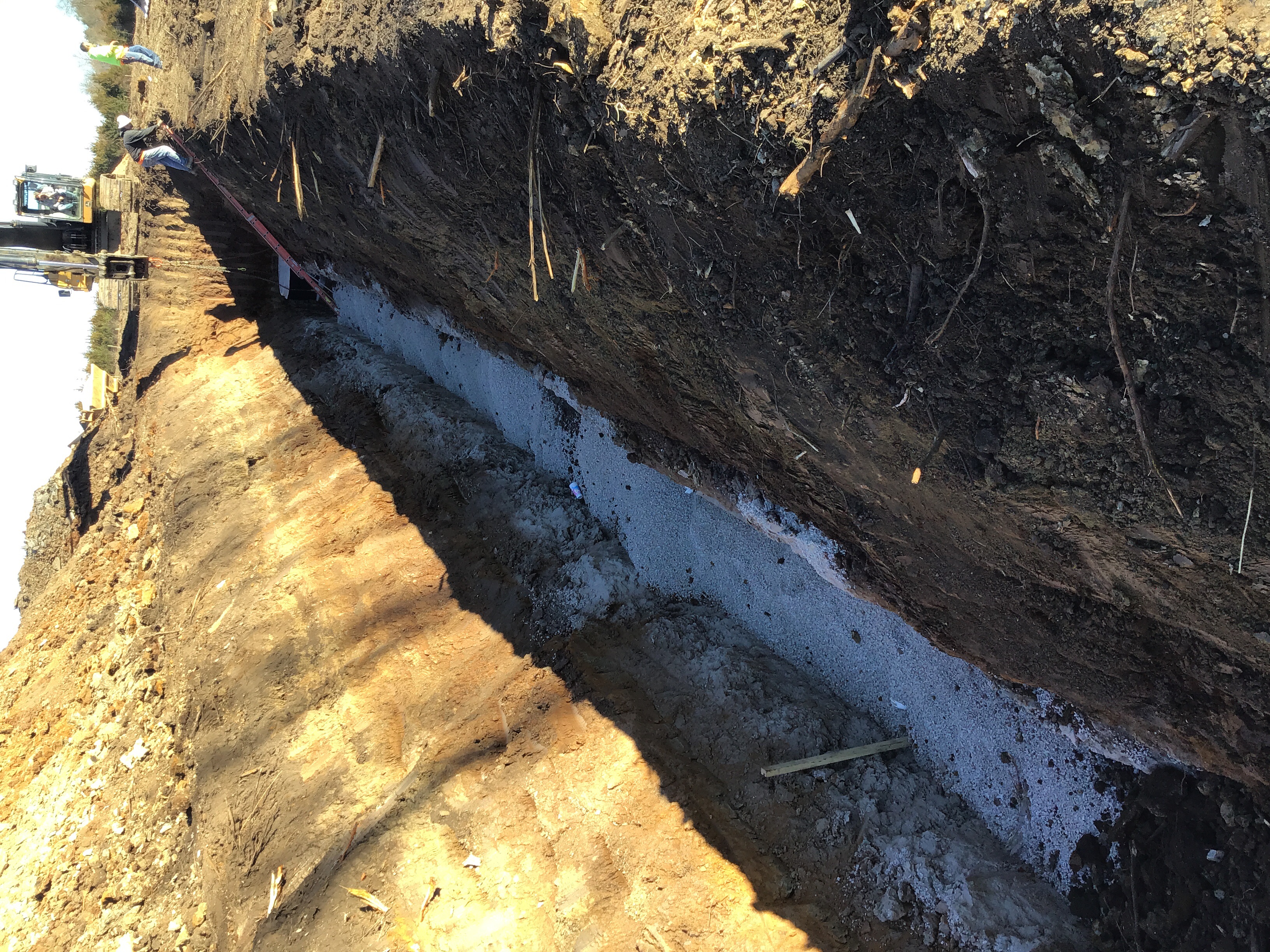

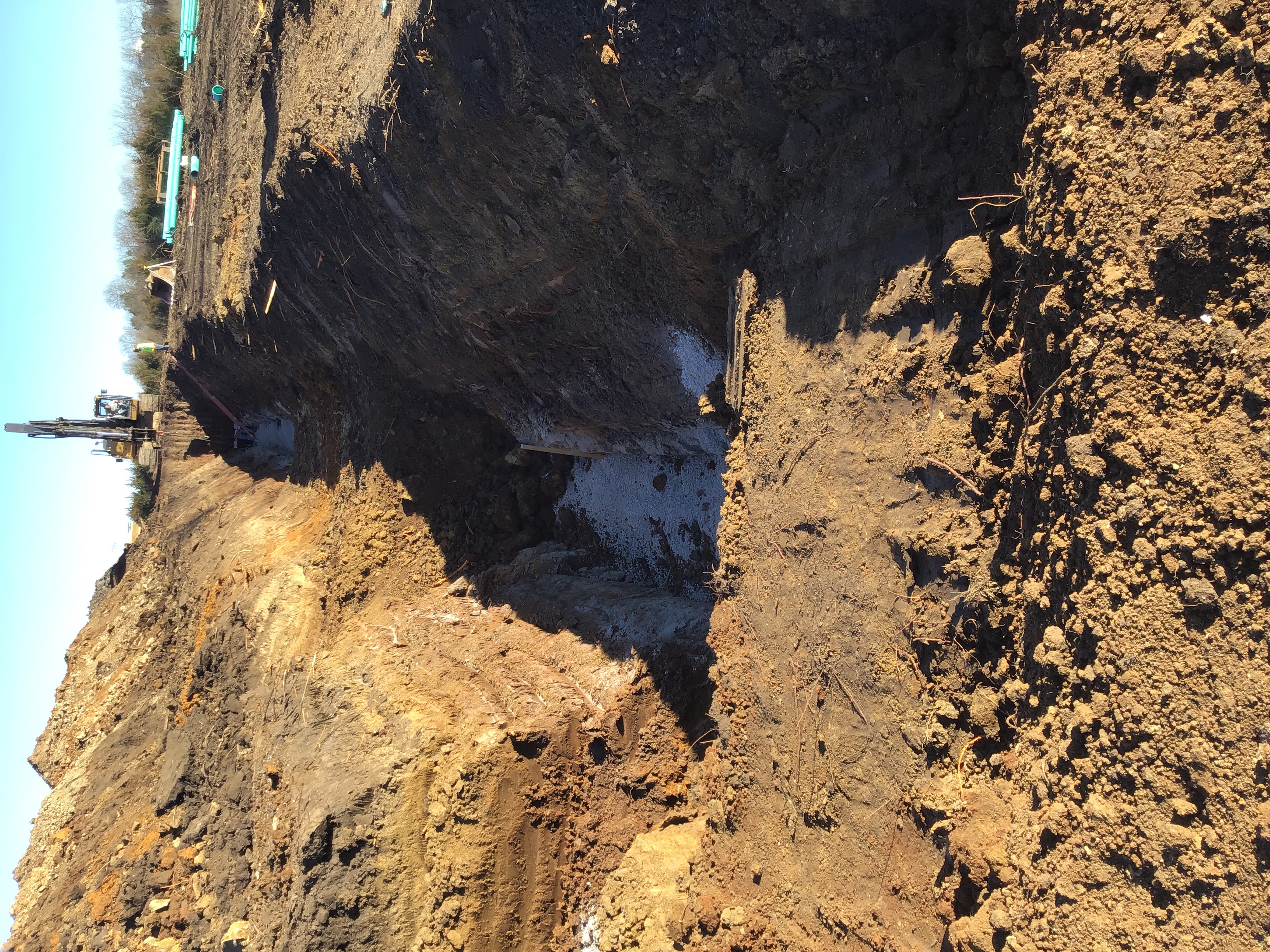

Sanitary Sewer Construction Inspection Partial 12/09/2020
Misc
Informational
12/09/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Sanitary - Material Verification Passed 12/09/2020
Misc
Informational
12/09/2020
John DiMauro 12/09/2020 I verified that the Materials on site are in compliance with the City of LS Design and construction standards. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/10/2020
Misc
Informational
12/09/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/10/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/14/2020
Misc
Informational
12/10/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/10/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/14/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/15/2020
Misc
Informational
12/14/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/14/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/14/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Misc
Informational
12/15/2020
John DiMauro 12/15/2020 3:18 PM The Redford crew installed approximately 100’ ft of the 8” main today. The crew plans to install service lines for lots 10, 41, 48 & 49 tomorrow. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 12/16/2020
Misc
Informational
12/15/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/15/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/15/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Misc
Informational
12/15/2020
John DiMauro 12/15/2020 3:18 PM The Redford crew installed approximately 100’ ft of the 8” main today. The crew plans to install service lines for lots 10, 41, 48 & 49 tomorrow. Photos are uploaded.
Misc
Informational
12/16/2020
John DiMauro 12/16/2020 9:43 AM The Redford crew is on site installing the SS line B. The crew is currently breaking rock to prepare for install.
Sanitary Sewer Construction Inspection Partial 12/21/2020 12/21/2020 12/21/2020
Misc
Informational
12/16/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/16/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/16/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Misc
Informational
12/16/2020
John DiMauro 12/15/2020 3:18 PM The Redford crew installed approximately 100’ ft of the 8” main today. The crew plans to install service lines for lots 10, 41, 48 & 49 tomorrow. Photos are uploaded.
Misc
Informational
12/16/2020
John DiMauro 12/16/2020 9:43 AM The Redford crew is on site installing the SS line B. The crew is currently breaking rock to prepare for install.
Misc
Informational
12/21/2020
John Jackson 12/21/20 1:55 PM The Redford crew installed service line to Lot 49. Contractor poured inver, backfilled field excavation, clean site. Compaction testing is schedule for tomorrow.
Sanitary Sewer Construction Inspection Partial 12/22/2020
Misc
Informational
12/21/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/21/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/15/2020 3:18 PM The Redford crew installed approximately 100’ ft of the 8” main today. The crew plans to install service lines for lots 10, 41, 48 & 49 tomorrow. Photos are uploaded.
Misc
Informational
12/21/2020
John DiMauro 12/16/2020 9:43 AM The Redford crew is on site installing the SS line B. The crew is currently breaking rock to prepare for install.
Misc
Informational
12/21/2020
John Jackson 12/21/20 1:55 PM The Redford crew installed service line to Lot 49. Contractor poured inver, backfilled field excavation, clean site. Compaction testing is schedule for tomorrow.
Misc
Informational
12/22/2020
John Jackson 12/22/2020 10:30 AM KCI testing did compaction test and contractor continued to backfill excavation on site.

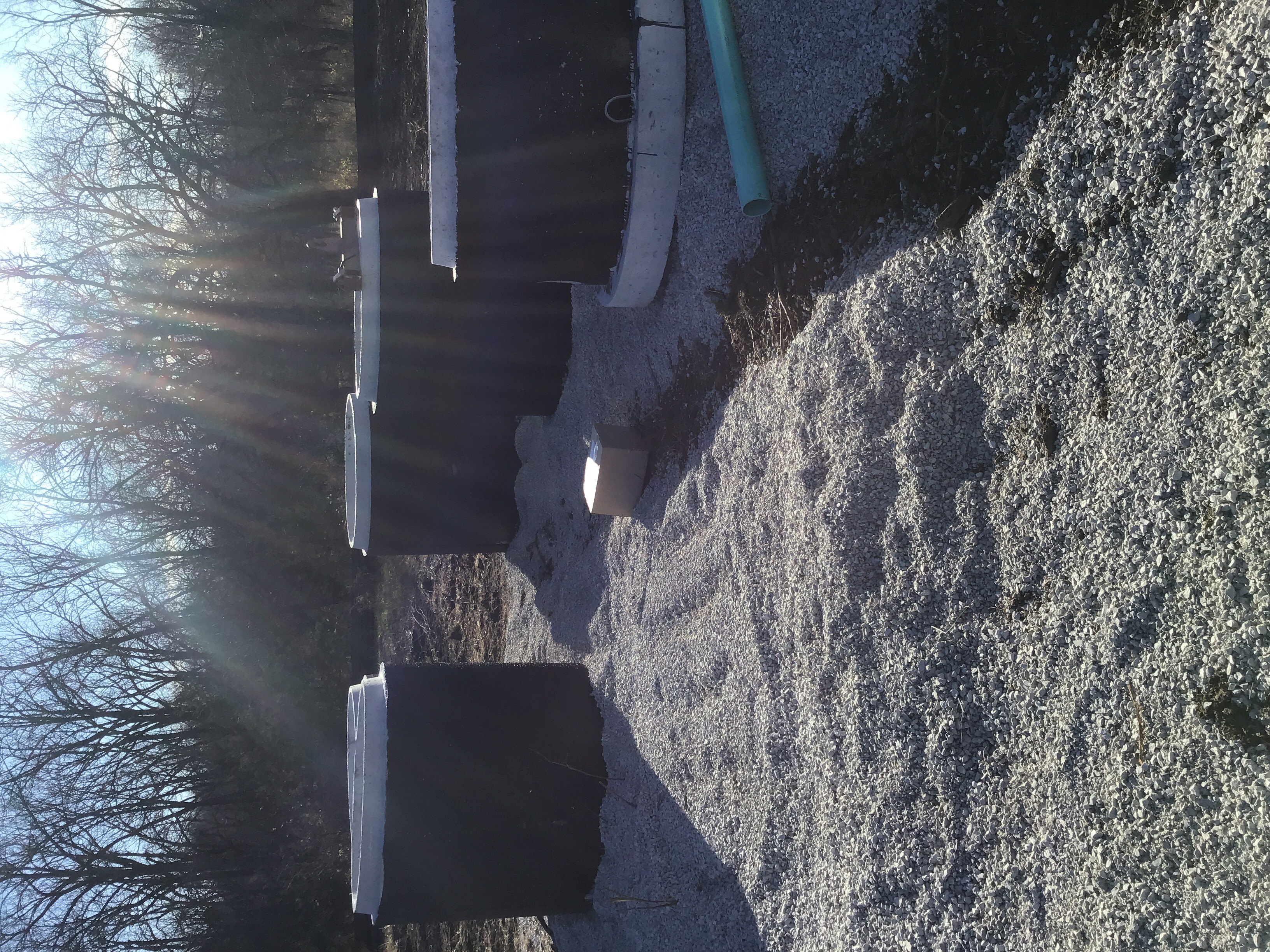

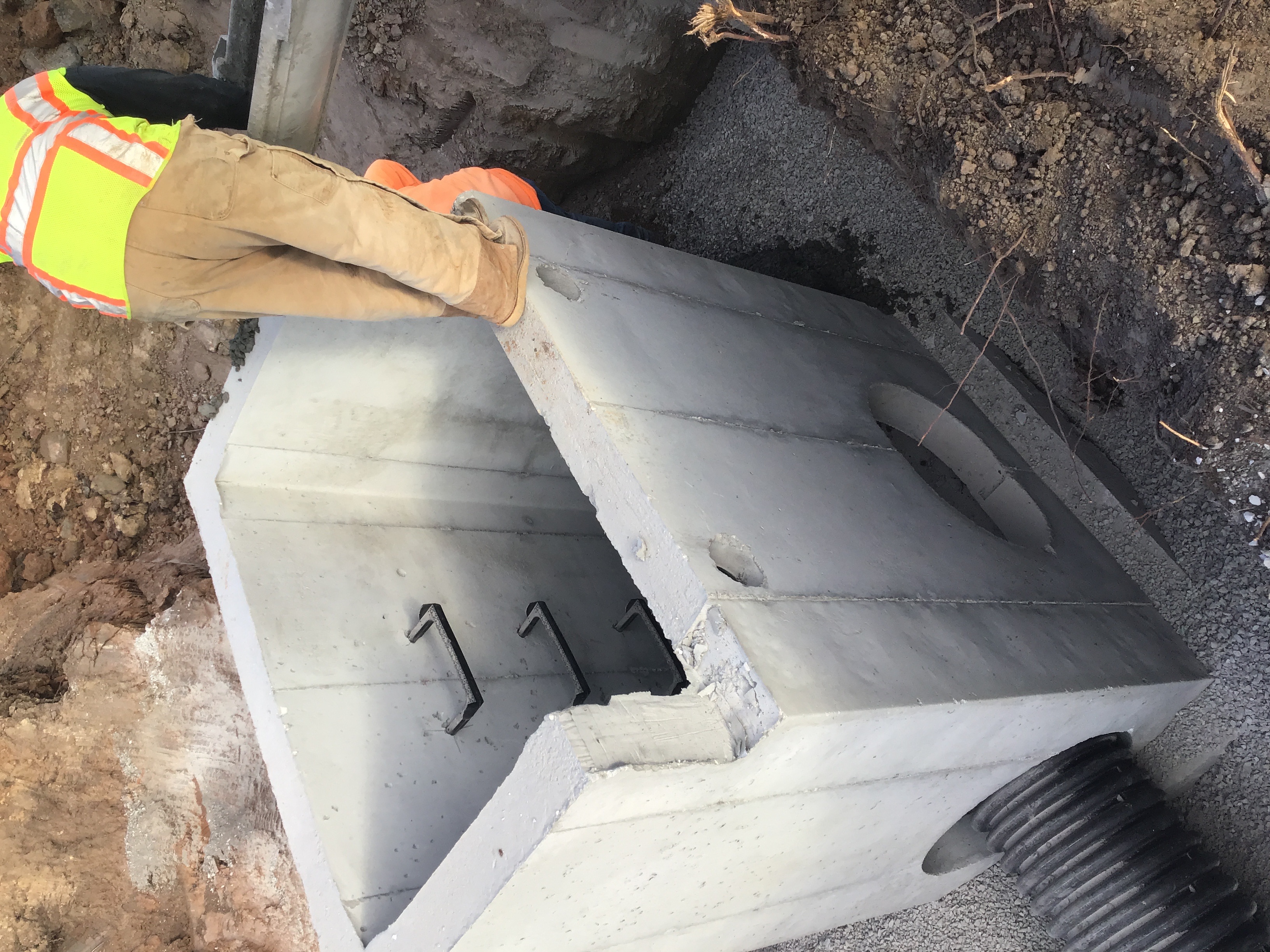

Storm Sewer Construction Inspection Partial 12/28/2020
Misc
Corrective Action Required
12/28/2020

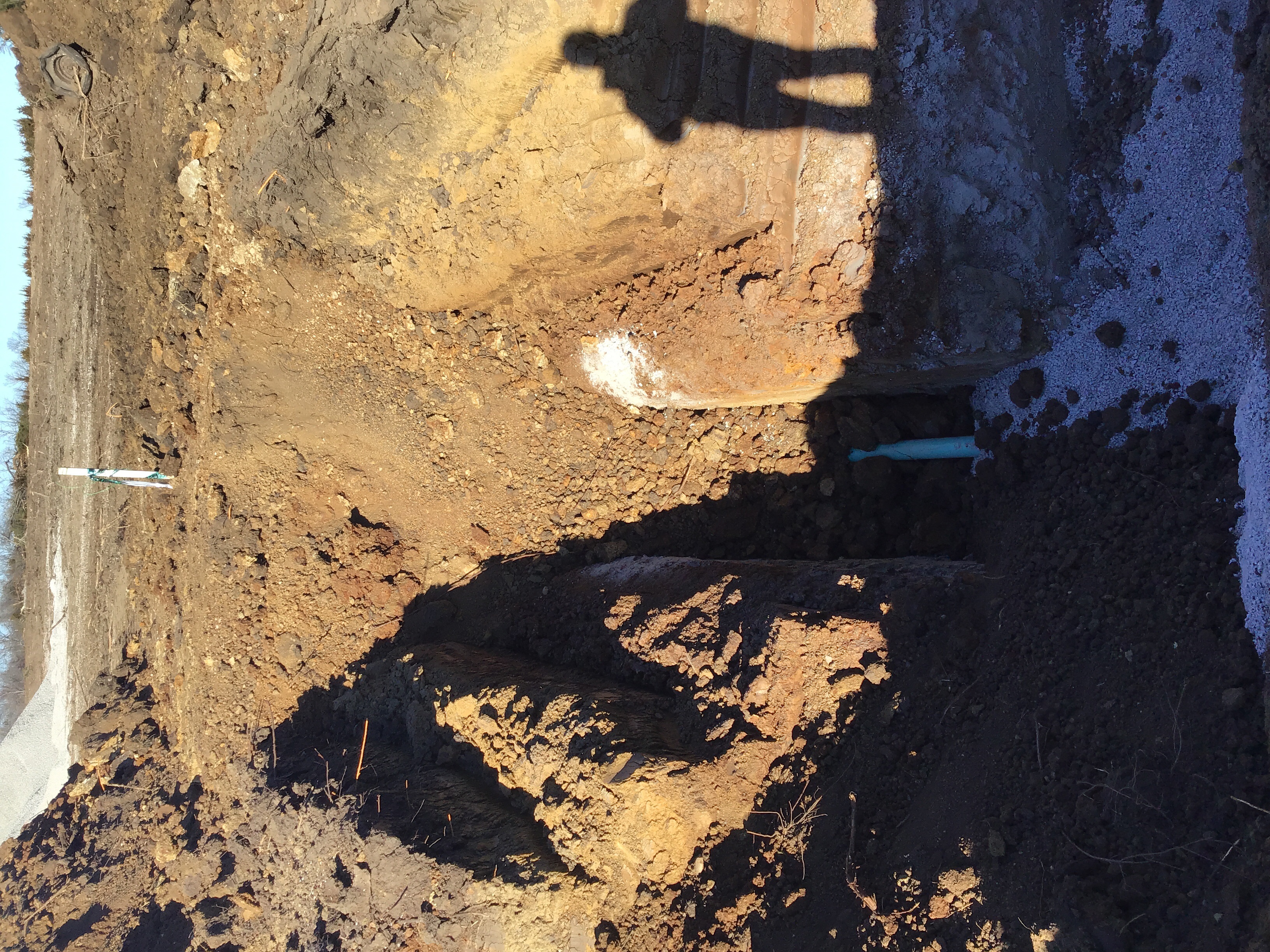

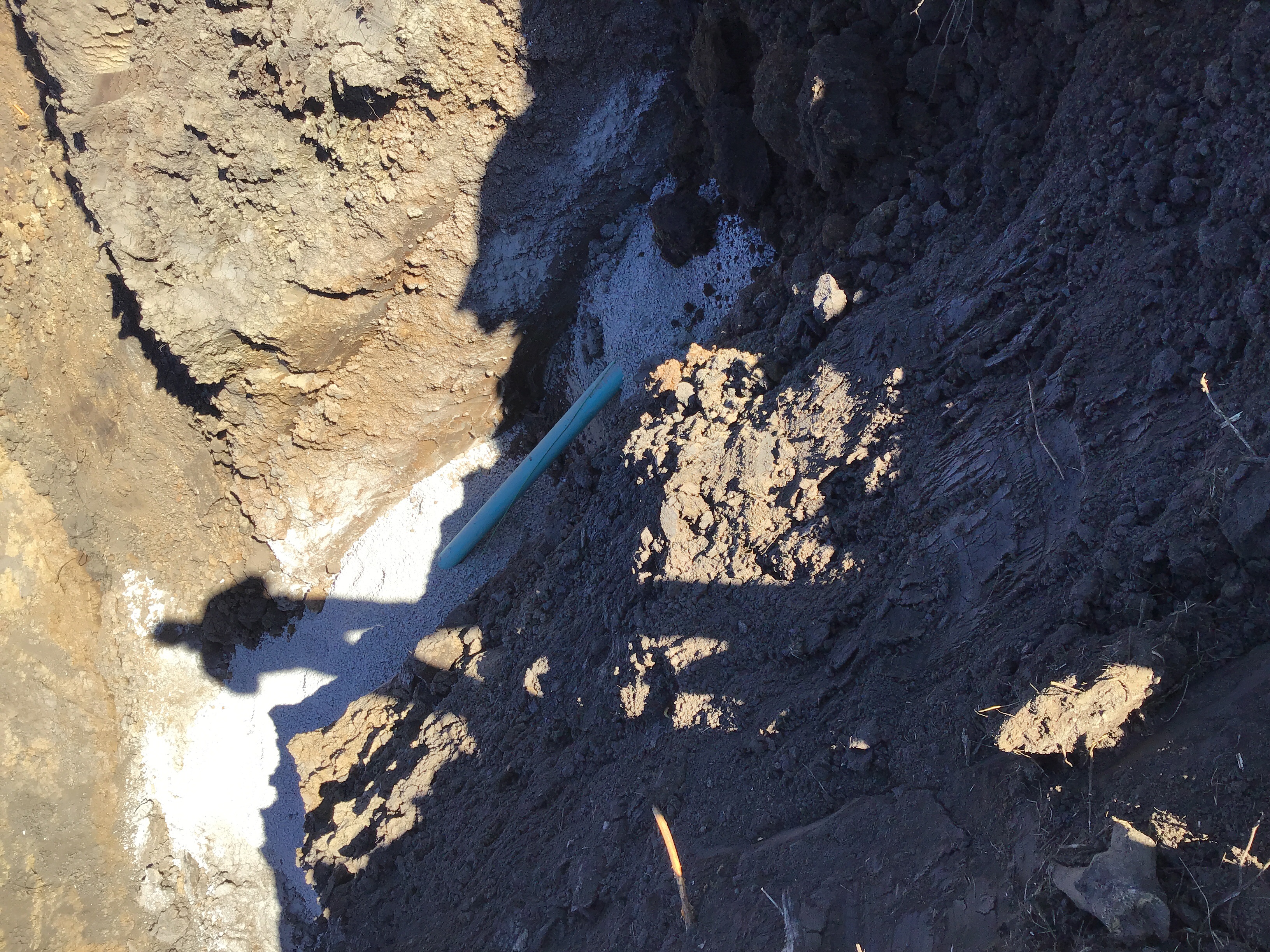

John DiMauro 12/28/2020 The Redford crew is on site working on Storm line C. The crew has the line installed from CI C-9 to CI C-12. The crew is pouring collars for the boxes this afternoon. Photos are uploaded.
Storm Sewer Construction Inspection Partial 1/11/2021 1/11/2021 01/11/2021
Misc
Corrective Action Required
12/28/2020
John DiMauro 12/28/2020 The Redford crew is on site working on Storm line C. The crew has the line installed from CI C-9 to CI C-12. The crew is pouring collars for the boxes this afternoon. Photos are uploaded.
Misc
Informational
01/11/2021
1-11-21 10:55am They have installed storm box C-11, C-12, C-13, C14 along with pipe. They are working on installing pipe from C-14 to C-15.
Storm Sewer Construction Inspection Partial 1/14/2021 1/14/2021 01/14/2021
Misc
Corrective Action Required
01/11/2021
John DiMauro 12/28/2020 The Redford crew is on site working on Storm line C. The crew has the line installed from CI C-9 to CI C-12. The crew is pouring collars for the boxes this afternoon. Photos are uploaded.
Misc
Informational
01/11/2021
1-11-21 10:55am They have installed storm box C-11, C-12, C-13, C14 along with pipe. They are working on installing pipe from C-14 to C-15. 1-14-21 3:21pm They have all of the inverts and collars poured and they are cleaning up around the site for the weekend.

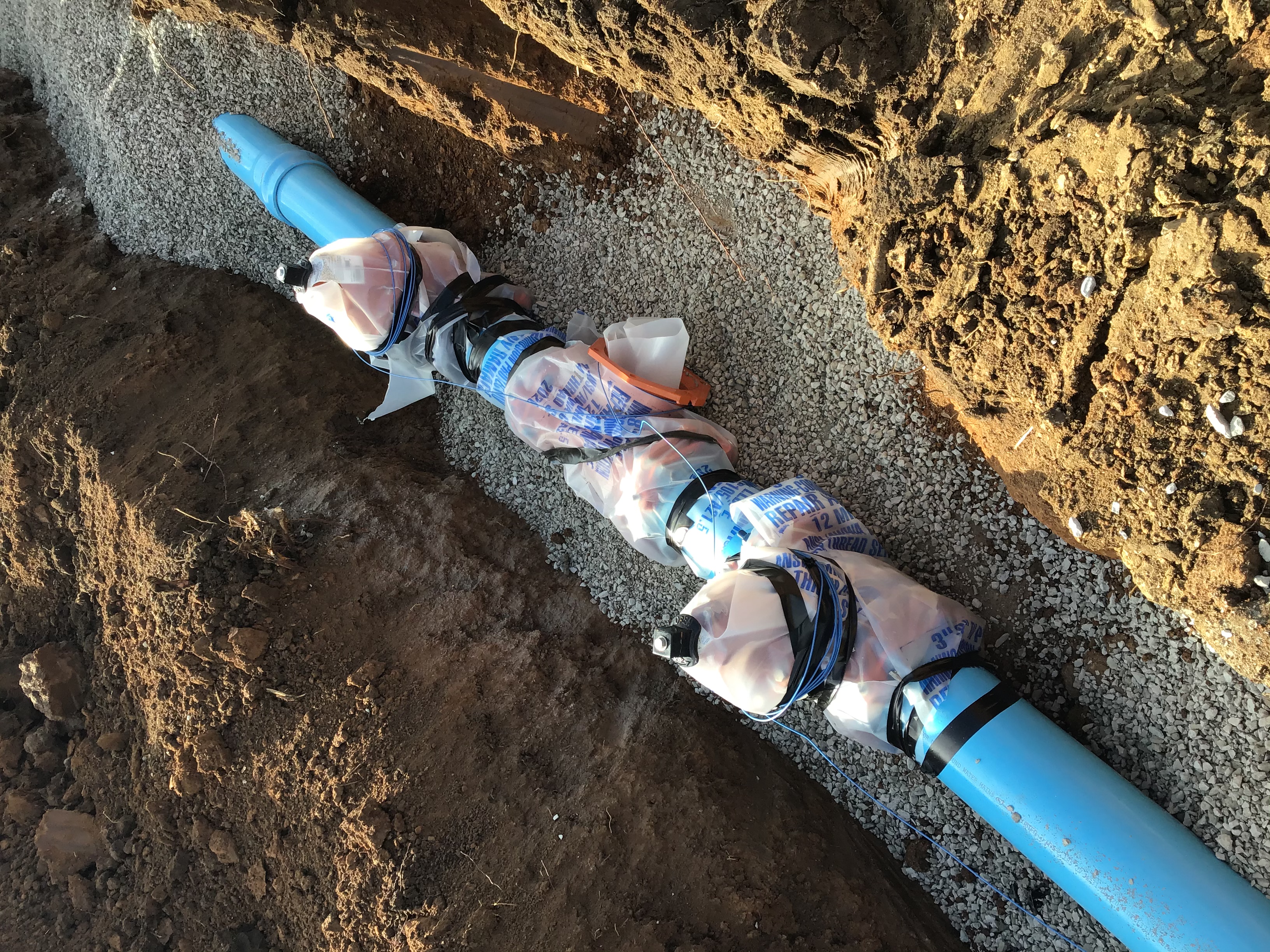

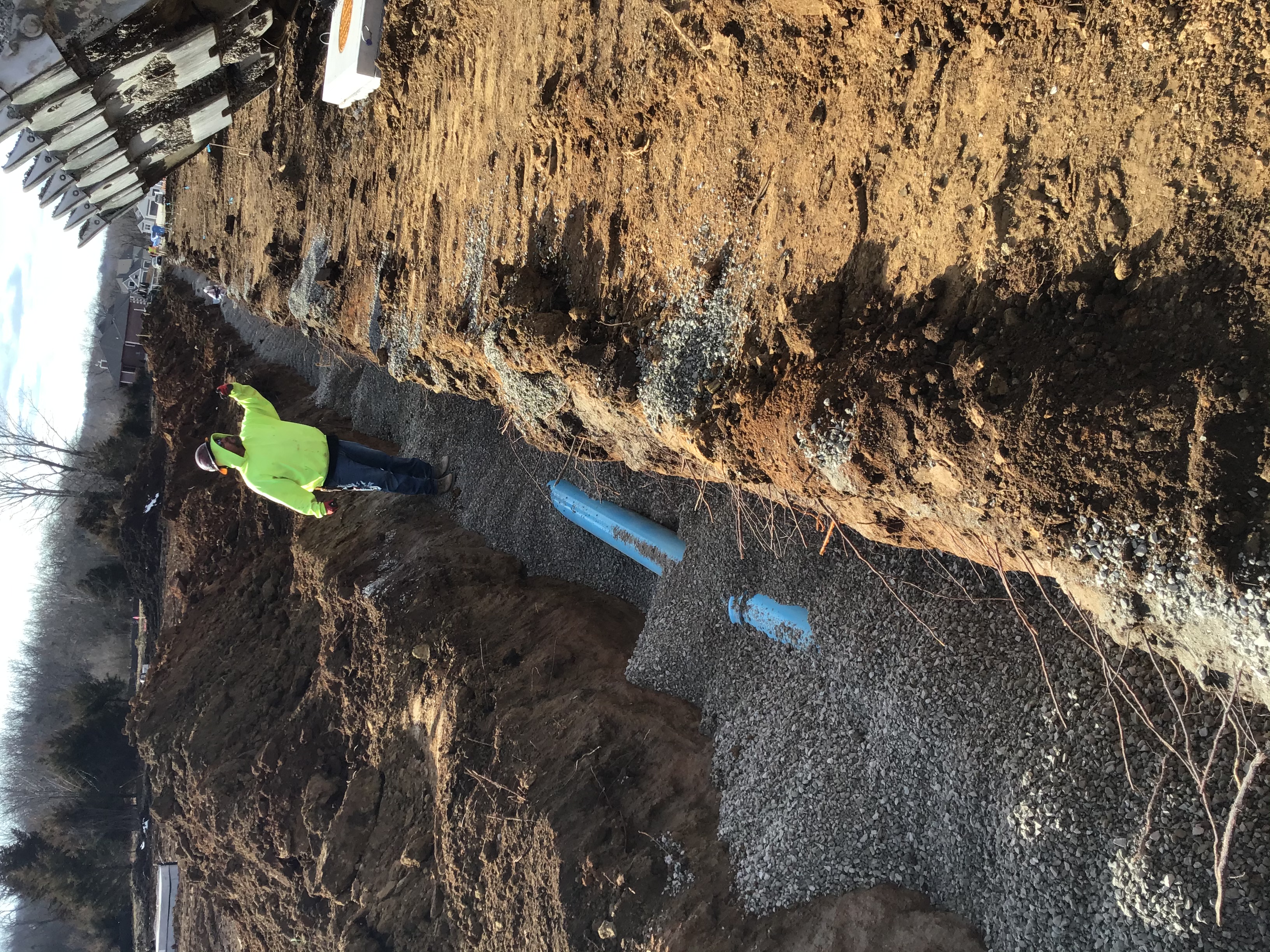

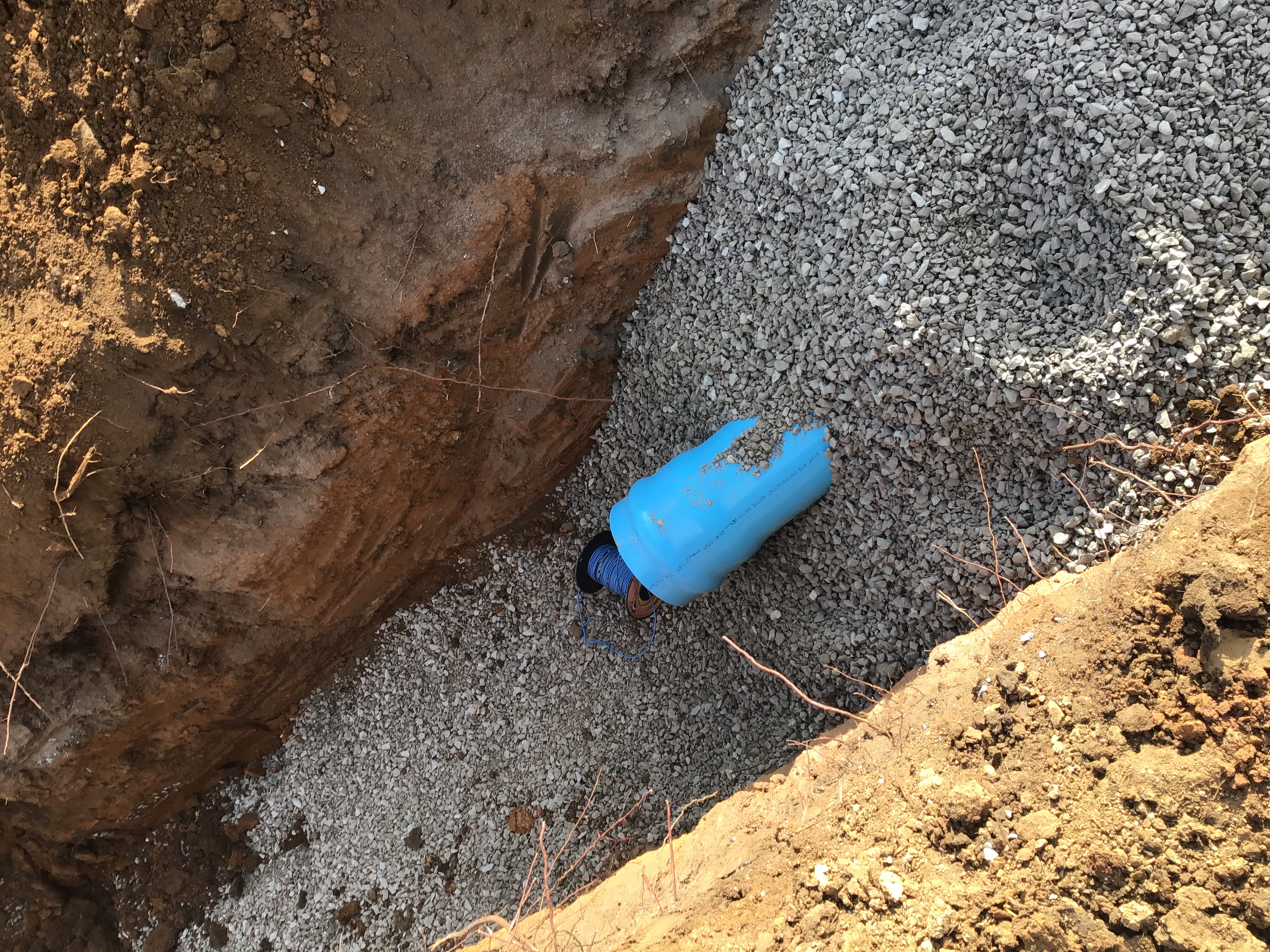

Water Line - Construction Inspection Partial 01/21/2021
Misc
Informational
01/19/2021
JOHN DIMAURO 01/19/2021 On Monday 1/18/21 the Redford crew installed approximately 100’ ft of the 8” main line C. Today 1/19/21 the crew has the line run to station 8+00. Photos of the work are uploaded.
Misc
Informational
01/21/2021
John DiMauro 01/21/2021 1:43 PM The Redford Construction crew completed water lines C & E today. The Crew set the hydrant at the tie in location 10+00 and poured the thrust block for the hydrant. Photos are uploaded.
Water Line - Hydrostatic Test Passed 01/29/2021
Misc
Informational
01/29/2021
John DiMauro 1/29/21 I observed the Hydrostatic pressure test for water lines C & E. The gauge held at 150 psi for 2 hours with no drop. Test Passed.
Water Line - Construction Inspection Partial 01/29/2021
Misc
Resolved
01/29/2021
JOHN DIMAURO 01/19/2021 On Monday 1/18/21 the Redford crew installed approximately 100’ ft of the 8” main line C. Today 1/19/21 the crew has the line run to station 8+00. Photos of the work are uploaded.
Misc
Resolved
01/29/2021
John DiMauro 01/21/2021 1:43 PM The Redford Construction crew completed water lines C & E today. The Crew set the hydrant at the tie in location 10+00 and poured the thrust block for the hydrant. Photos are uploaded.
Misc
Informational
01/29/2021
John DiMauro 1/29/21 Following the hydrostatic pressure test, I observed the Redford crew chlorinate the water lines C & E. I verified the correct chlorine residual at the end of line test locations. We will flush the line tomorrow morning.
Water Line - Construction Inspection Partial 02/01/2021
Misc
Informational
01/29/2021
John DiMauro 1/29/21 Following the hydrostatic pressure test, I observed the Redford crew chlorinate the water lines C & E. I verified the correct chlorine residual at the end of line test locations. We will flush the line tomorrow morning.
Misc
Informational
02/01/2021
John DiMauro 2/1/21 The Redford crew flushed the water line on Saturday 1/30/21. I observed the correct chlorine residual at test locations.
Water Line - Coliform Test 1 Partial 02/01/2021
Misc
Informational
02/01/2021
John DiMauro 2/1/21 I collected the day 1 samples and delivered them to Blue Valley Lab. We will know the results in 24 hours.
Water Line - Coliform Test 2 Partial 02/02/2021
Misc
Informational
02/02/2021
John DiMauro 2/2/21 I collected the day 2 water samples for water lines C & E. I’m about to deliver them to Blue Valley Labs this afternoon. We will know the results in 24 hours.
Water Line - Coliform Test 1 Passed 02/02/2021
Misc
Informational
02/01/2021
John DiMauro 2/1/21 I collected the day 1 samples and delivered them to Blue Valley Lab. We will know the results in 24 hours.
Sanitary Sewer - Mandrel Passed 02/23/2021
Misc
Informational
02/23/2021
JOHN DIMAURO 02/23/2021 I observed the Redford crew pull the mandrel through SS line B with no deflection. I verified the correct mandrel was used for the 8” line. Test Passed.
Sanitary Sewer - Air Test Passed 02/23/2021
Misc
Informational
02/23/2021
JOHN DIMAURO 02/23/2021 I observed the SS psi test for both line segments on line B. Both sections of line held at 4 psi for the required time length with no drop. Tests Passed.
Sanitary Sewer - Vacuum Passed 02/23/2021
Misc
Informational
02/23/2021
JOHN DIMAURO 02/23/2021 I observed the vacuum test for both manholes B5 & B6. Both manholes held a mercury level of 10 with no drop for the required time limit. Tests Passed
Pavement-Stabilized Subgrade Partial 04/13/2021
Misc
Informational
04/13/2021
The stabilized subgrade was I nstalled last Tuesday 4/6. Portland was the chemical subgrade that was used. The geotechnical engineer approved the amount used. We are planning doing. A proofroll on the stabilized subgrade at 3 this afternoon.
Pavement-Stabilized Subgrade Passed 4/13/2021 04/14/2021
Misc
Informational
04/13/2021
The stabilized subgrade was I nstalled last Tuesday 4/6. Portland was the chemical subgrade that was used. The geotechnical engineer approved the amount used. We are planning doing. A proofroll on the stabilized subgrade at 3 this afternoon.
Misc
Informational
04/14/2021
The proofroll passed except for 2 small area's that we added rock on this morning and did another proof roll that passed for the stabilized subgrade only.
Pavement-Aggregate Base Passed 4/14/2021 04/14/2021
Misc
Informational
04/14/2021
The aggregate base rock (MO Type 5) has been isntalled and is setting up to be ready for a proof roll for curb installation.
Pavement-Curb Construction Partial 04/22/2021
Misc
Informational
04/22/2021
On Wednesday, 4-21-2021. Spalding Contractors performed a curb proof roll. It passed city specification.
Misc
Informational
04/22/2021
On Thursday, 4-22-2021. JK Concrete installed CG-1 and CG-2 curbing. Contractor also formed all CI throats to be poured on tomorrow. All curbing is cured.
Pavement-Proof Roll Passed 04/30/2021
Misc
Informational
04/30/2021
On Friday, 4-30-2021. Contractor performed a proof roll for the subgrade before asphalt installation.
Pavement-Surface Passed 05/01/2021
Misc
Informational
05/03/2021
On Monday, 5-03-2021. Culvert’s Asphalt installed the surface lift on project completing the asphalt pavement.
Pavement-Surface Passed 05/01/2021
Misc
Informational
05/01/2021
On Saturday, 5-01-2021. Culvert Asphalt laid the asphalt base coarse for the roadway and KC Testing performed the asphalt density testing.
Site Visit Complete 06/03/2021
Record Drawing Review Passed 7/27/2021 09/27/2021
Grading/Excavation/Fill Inspection Passed 09/27/2021
Sanitary - Material Verification Passed 09/27/2021
Sanitary Sewer - Air Test Passed 09/27/2021
Sanitary Sewer - Mandrel Passed 09/27/2021
Sanitary Sewer - Vacuum Passed 09/27/2021
Pavement-Surface Passed 09/27/2021
Install Street and Stop Signs Passed 09/27/2021

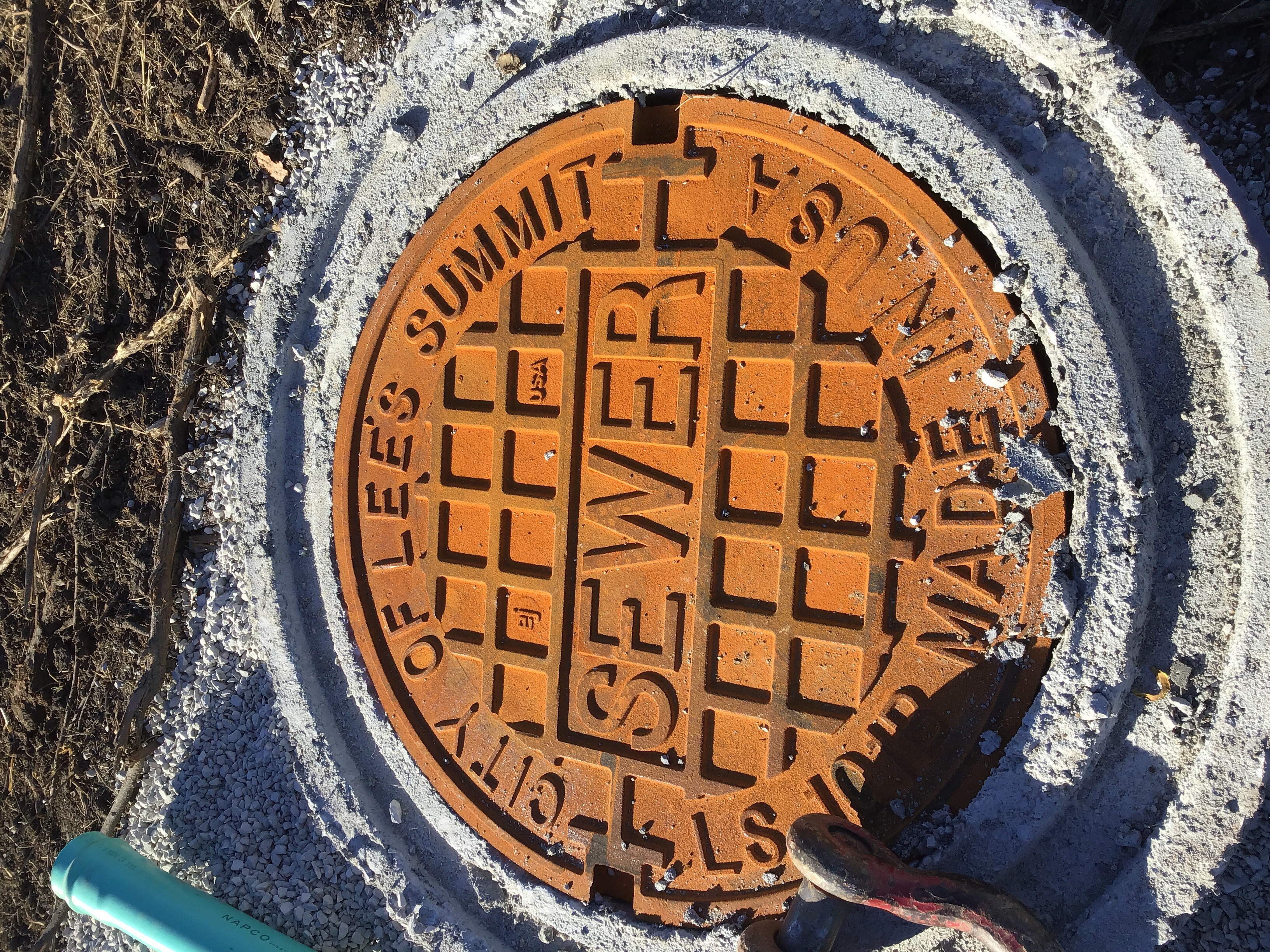

Sanitary Sewer Construction Inspection Passed 09/27/2021
Misc
Informational
12/22/2020
John DiMauro 12/09/2020 2:27 PM The Redford crew started the SS Install Monday 12/07/2020. The crew cored into the existing MH B-4 and started laying the 8” SS main to the East. The crew is run up to MH B-5 and set the MH base this afternoon while I was on site. Photos of the work are uploaded. The crew plans to have the compaction testing performed at a later date.
Misc
Informational
12/22/2020
John DiMauro 12/10/2020 2:18 pm The Redford crew is on site continuing the SS line B install. The crew installed service lines 38, 39, 46 & 47. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/14/2020 3:45 PM The Redford crew is on site continuing the SS Line B install. The crew installed approximately 56’f of the 8” line going east out of MH B-5. The crew ran into heavy rock that slowed down progress. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/15/2020 3:18 PM The Redford crew installed approximately 100’ ft of the 8” main today. The crew plans to install service lines for lots 10, 41, 48 & 49 tomorrow. Photos are uploaded.
Misc
Informational
12/22/2020
John DiMauro 12/16/2020 9:43 AM The Redford crew is on site installing the SS line B. The crew is currently breaking rock to prepare for install.
Misc
Informational
12/22/2020
John Jackson 12/21/20 1:55 PM The Redford crew installed service line to Lot 49. Contractor poured inver, backfilled field excavation, clean site. Compaction testing is schedule for tomorrow.
Misc
Informational
12/22/2020
John Jackson 12/22/2020 10:30 AM KCI testing did compaction test and contractor continued to backfill excavation on site.
Sanitary Sewer - Camera Test Passed 9/27/2021 09/27/2021
Water Line - Coliform Test 2 Passed 2/9/2021 2/9/2021 09/27/2021
Documents & Images
Date Uploaded File Type Document Name
12/01/2020 Receipt Receipt for transaction: 2020-007785
12/02/2020 Letter DE-Permit
12/08/2020 Approved Plans Whispering Woods 2nd Plat Erosion Control Plans Approved 12.8.20
12/08/2020 Approved Plans Whispering Woods 2nd Plat Street and Storm Approved 12.8.20
12/08/2020 Approved Plans Whispering Woods 2nd Plat Sanitary Sewer Plans Approved 12.8.20

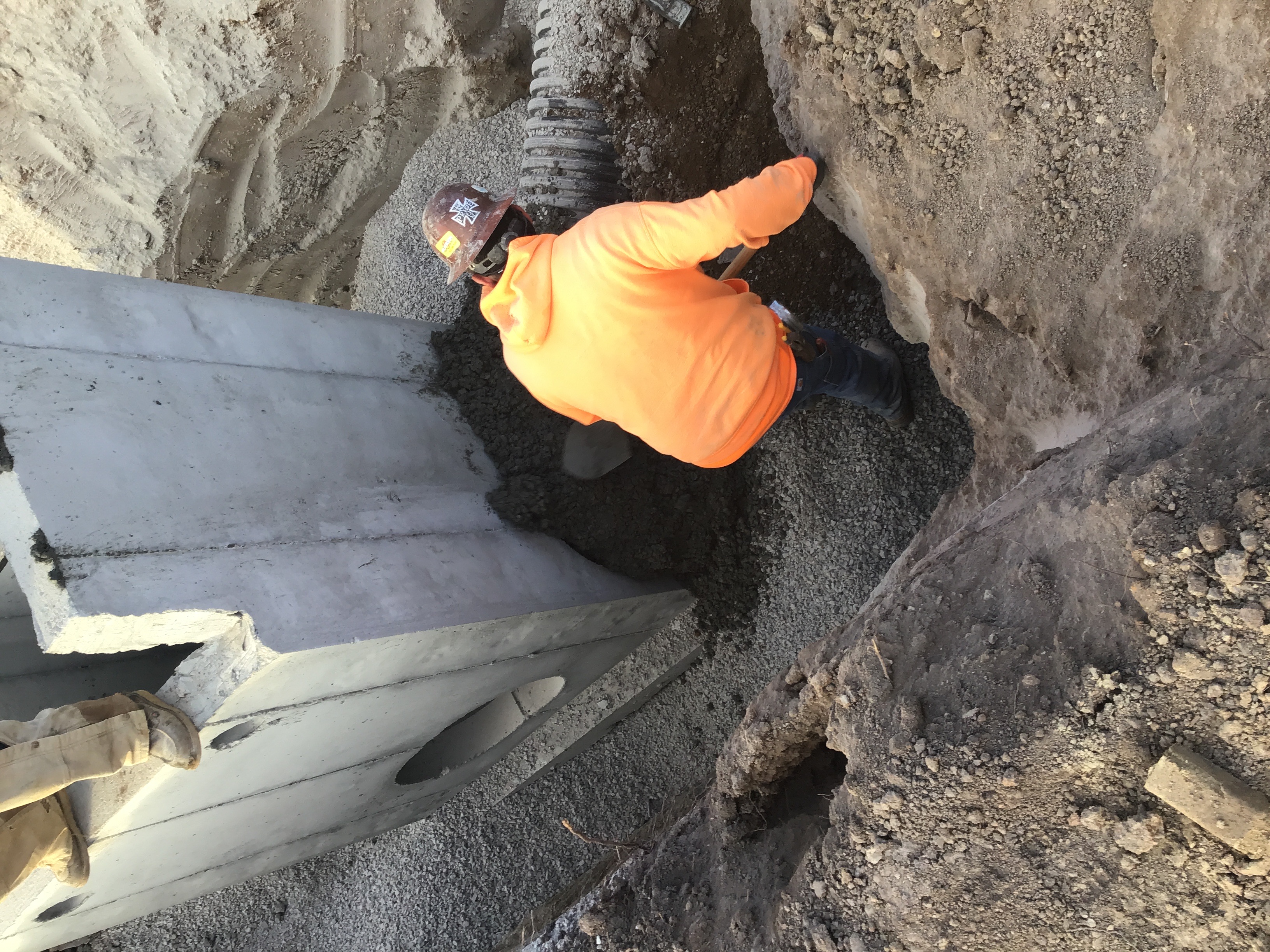

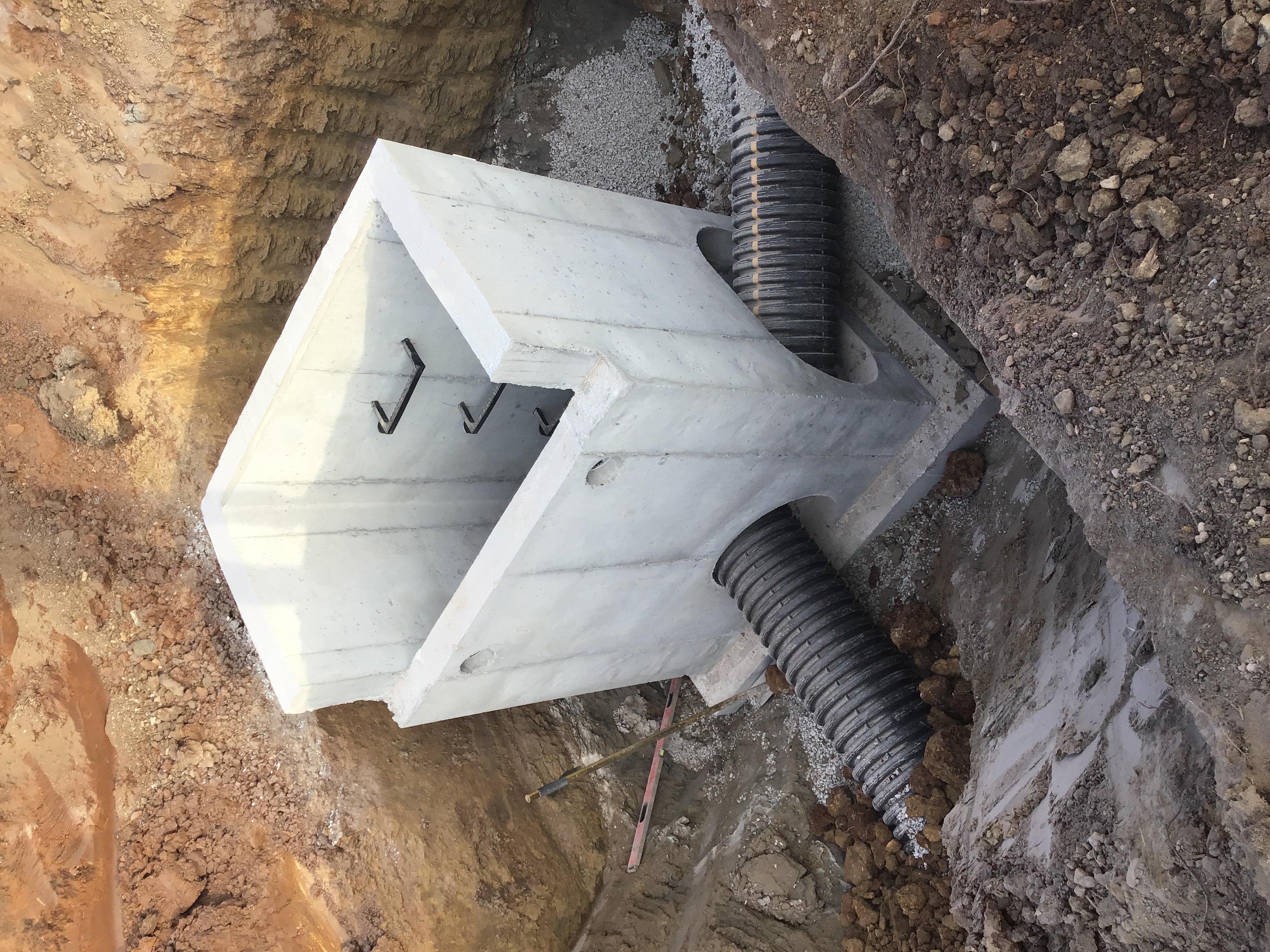

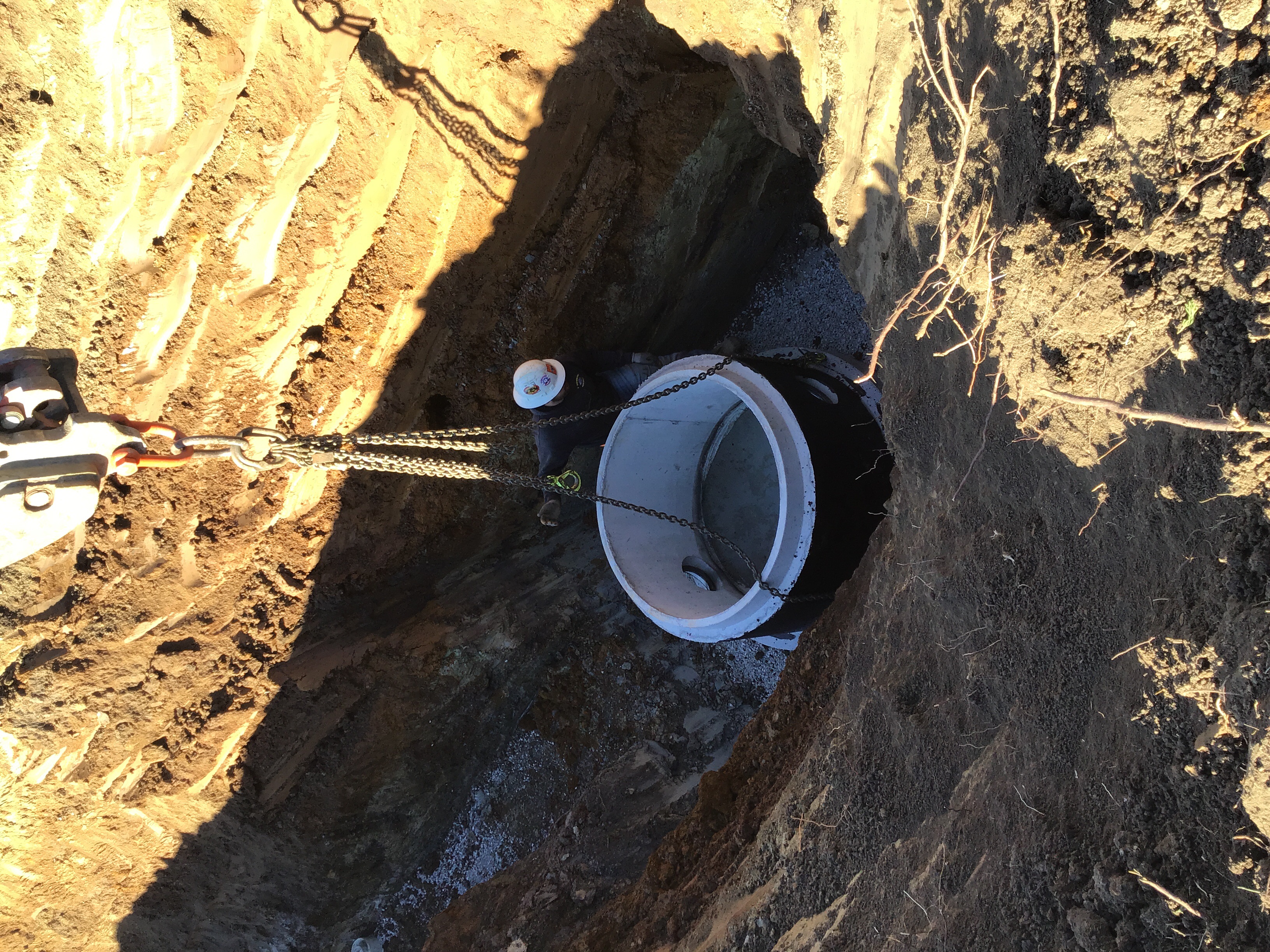

12/09/2020 Photograph Core into SS MH B-4.jpg
12/09/2020 Photograph SS lot 44.jpg
12/09/2020 Photograph SS lot 36.jpg

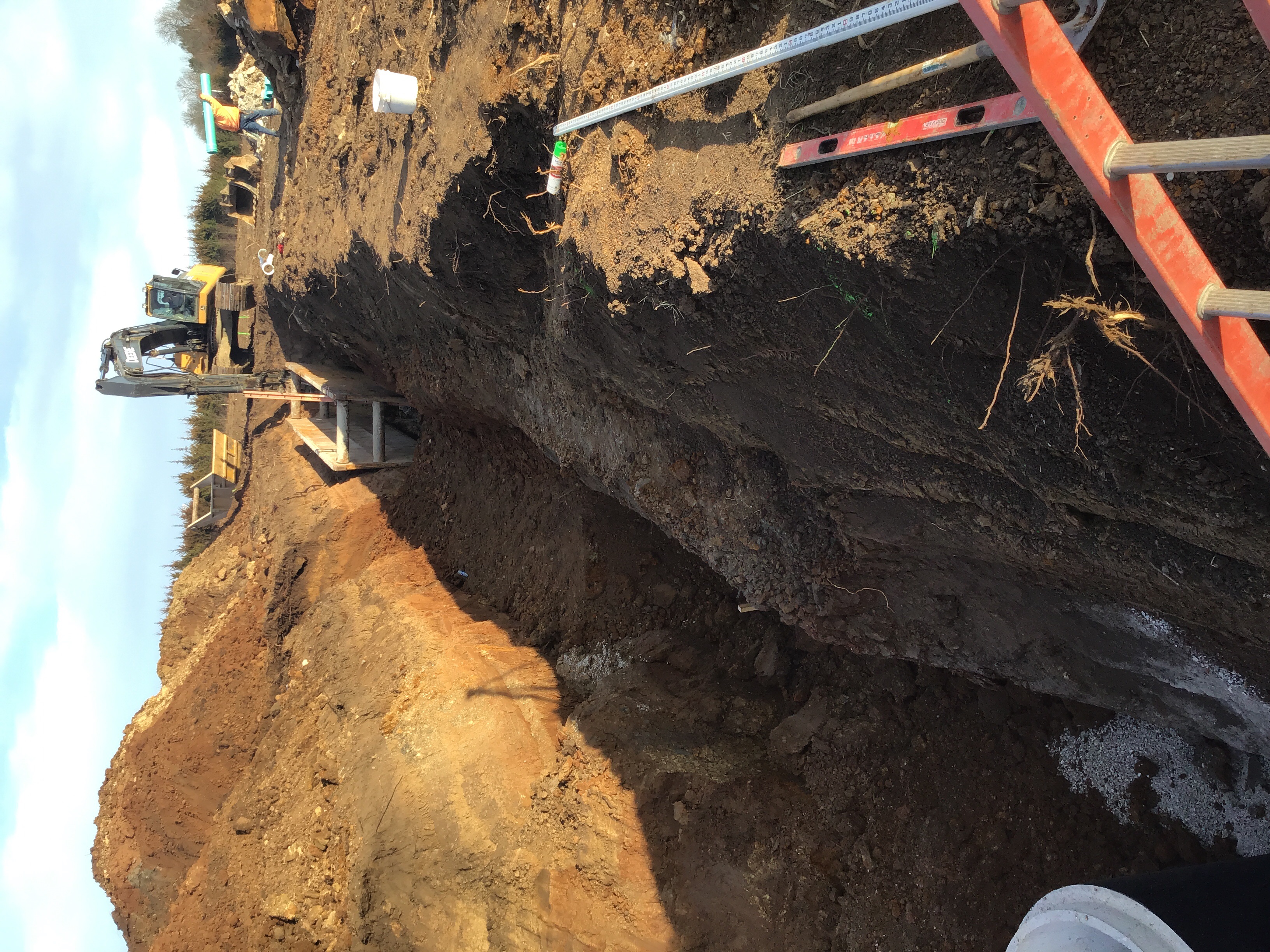

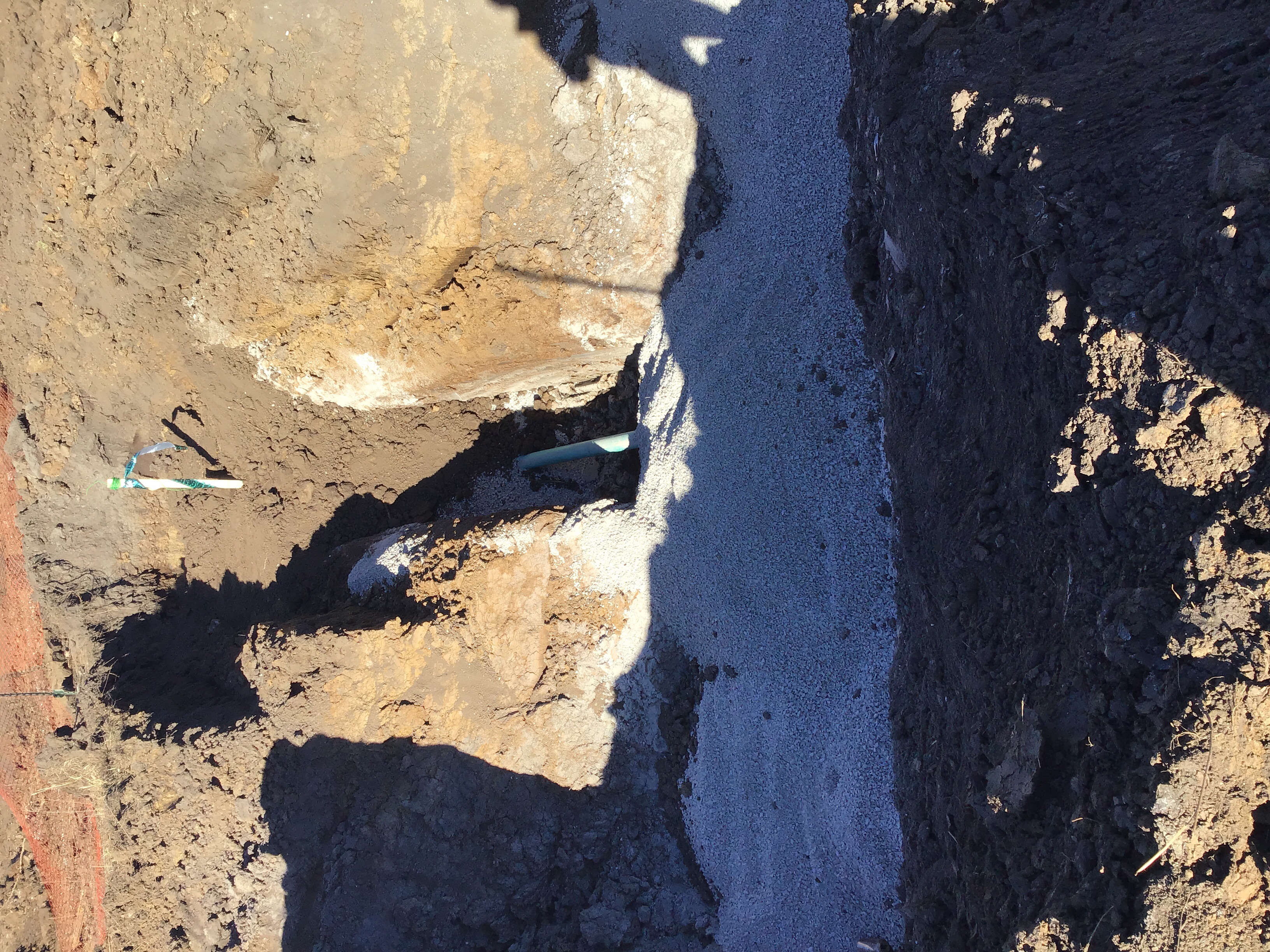

12/09/2020 Photograph SS line B.jpg
12/09/2020 Photograph SS lot 38.jpg
12/09/2020 Photograph SS line B.jpg0

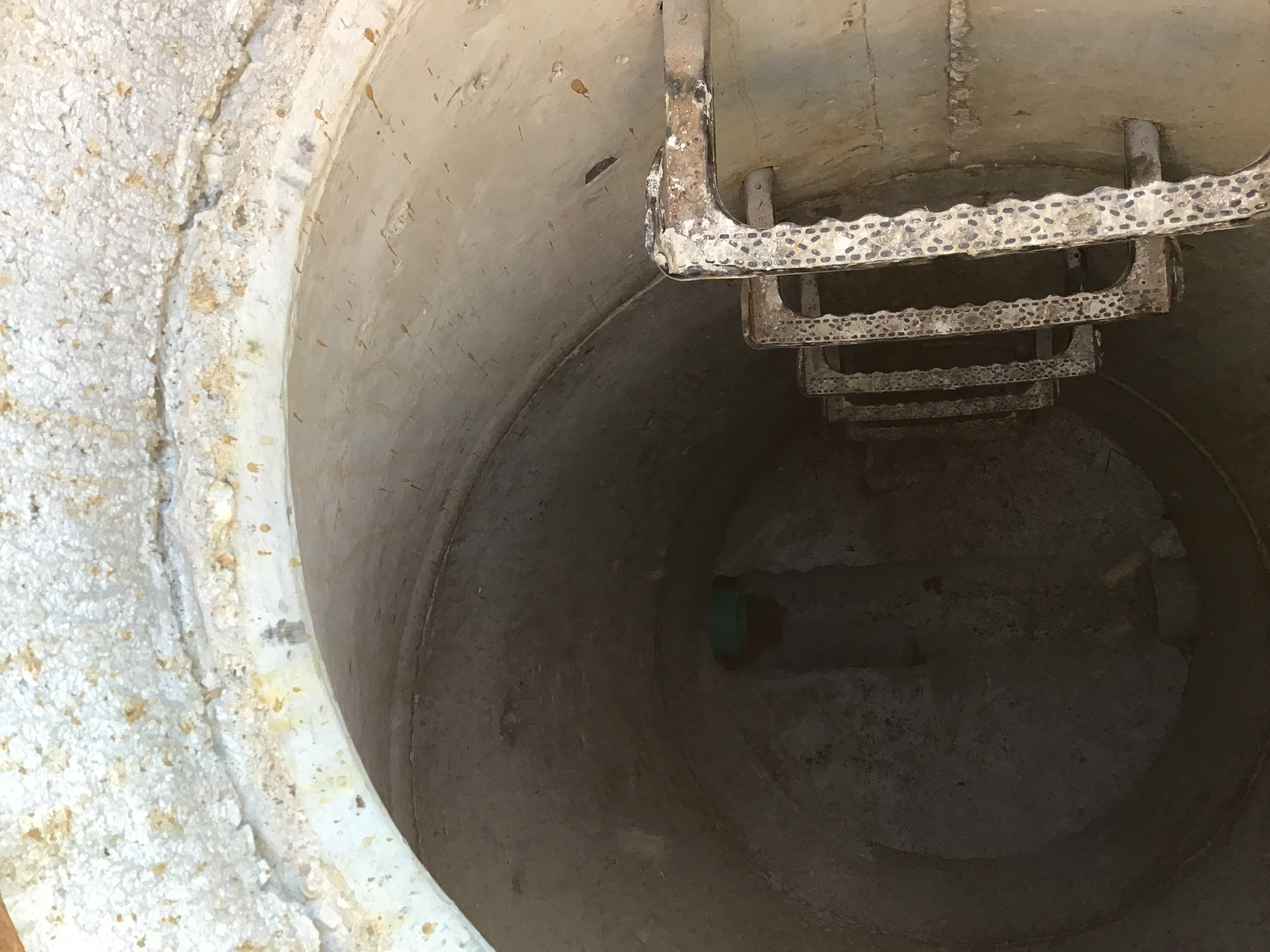

12/09/2020 Photograph SS MH B-5.jpg
12/09/2020 Photograph Wye fitting.jpg

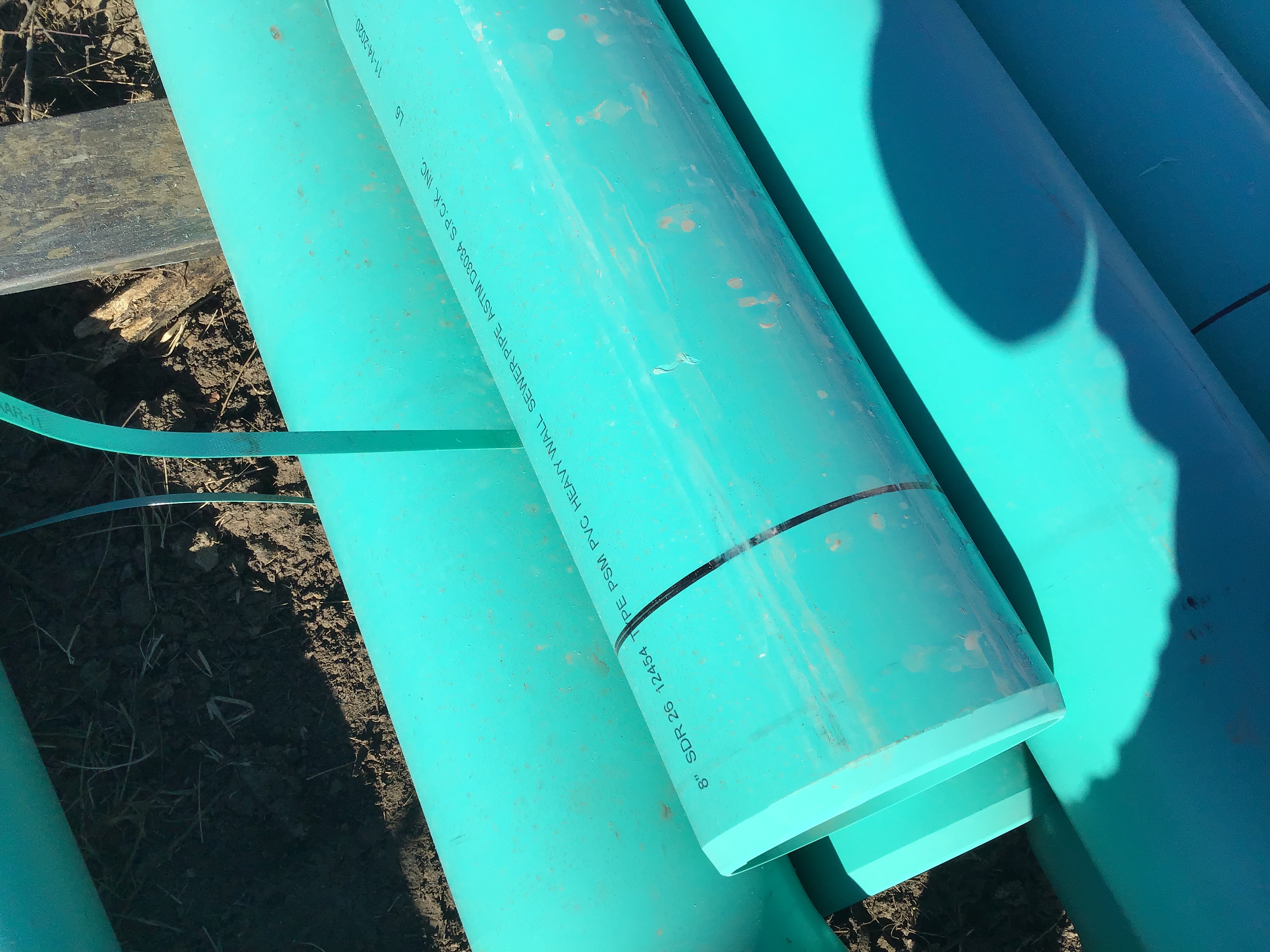

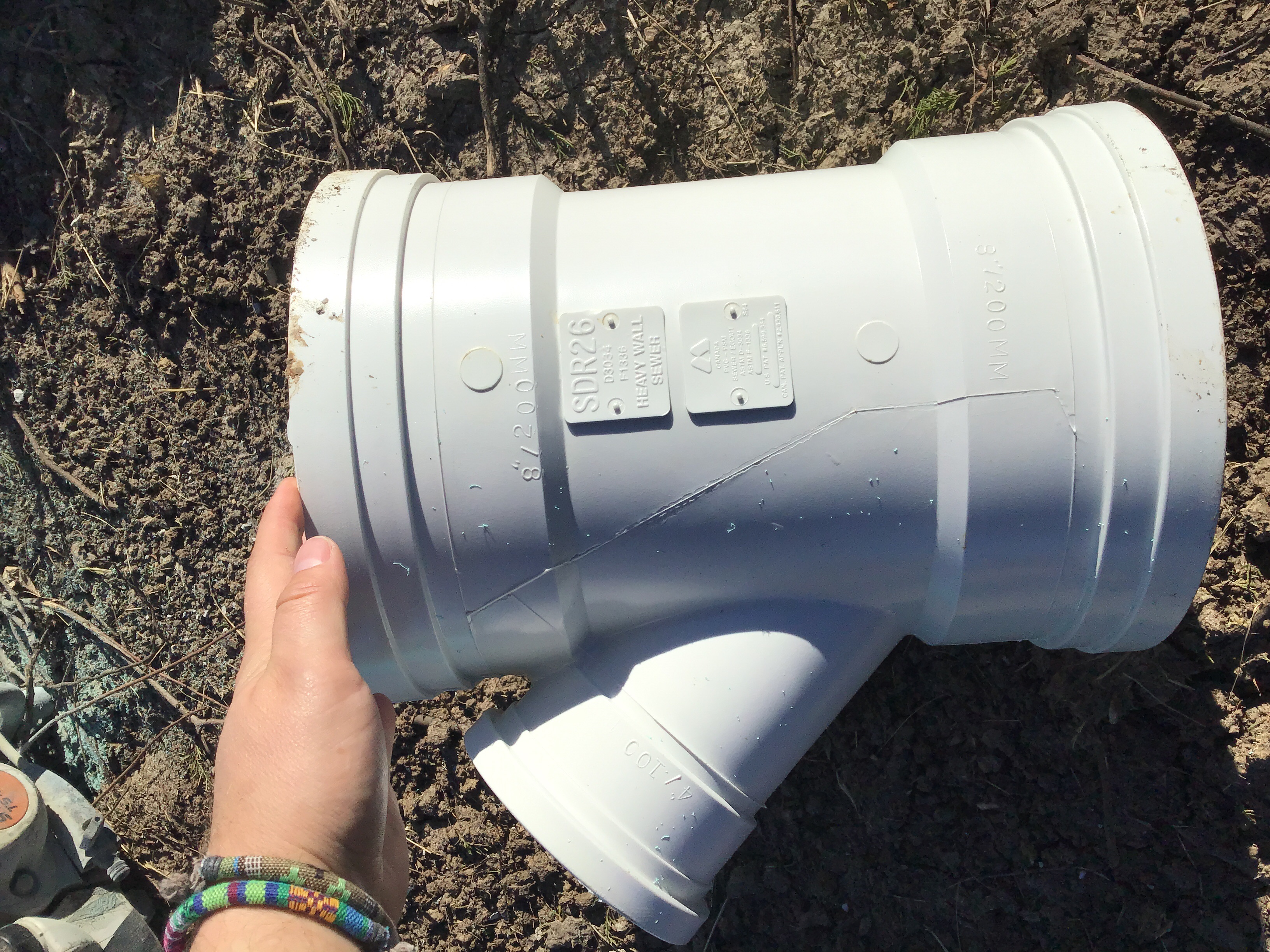

12/09/2020 Photograph 4” SDR 26 pipe.jpg
12/09/2020 Photograph 8” SDR 26 pipe.jpg

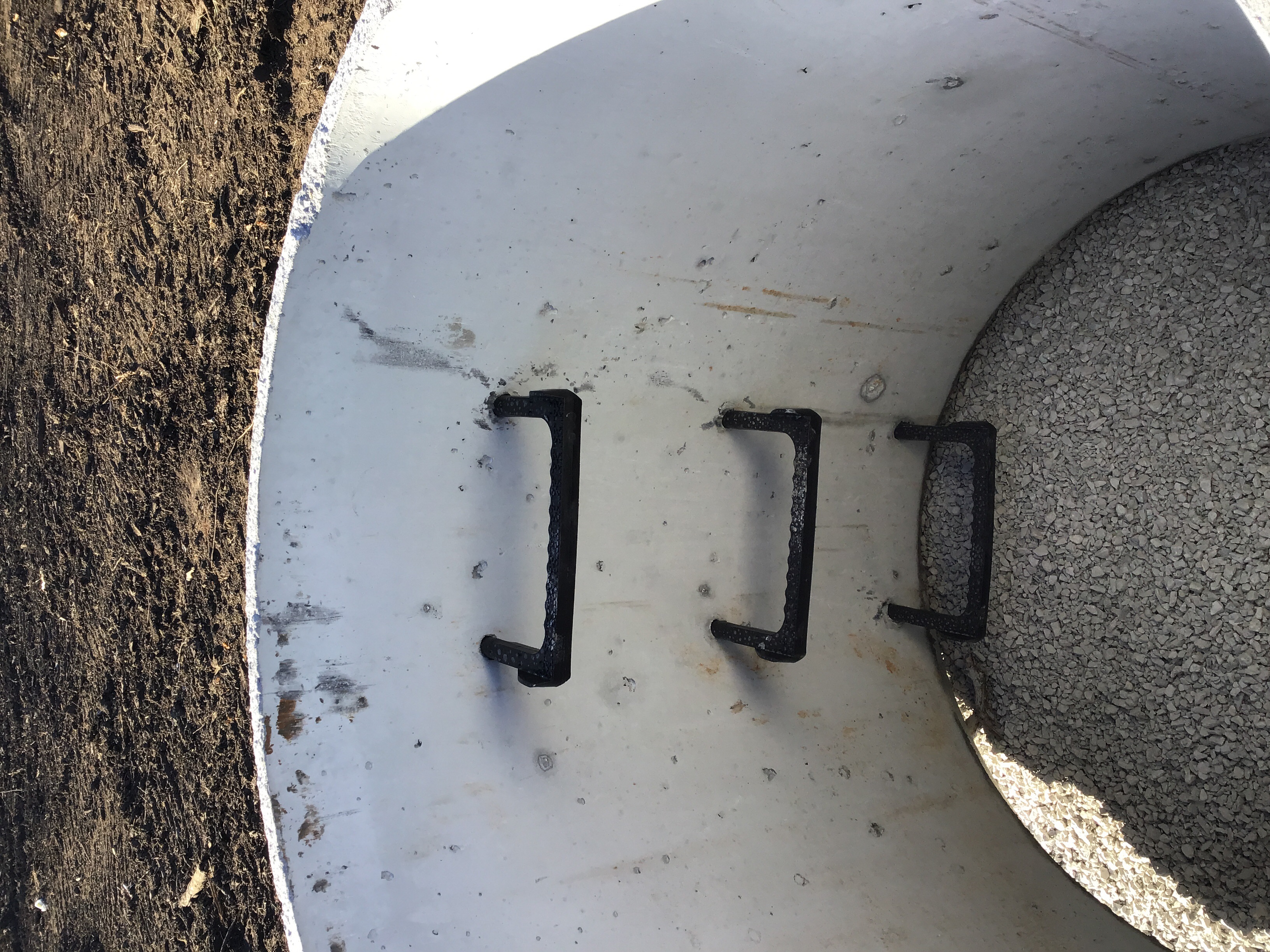

12/09/2020 Photograph SS MH materials.jpg
12/09/2020 Photograph SS Materials.jpg
12/09/2020 Photograph SS MH Materials .jpg
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/14/2020 Photograph SS Line B install .jpg
12/14/2020 Letter INSPECTION SUMMARY
12/15/2020 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/16/2020 Approved Plans Whispering Woods 2nd Plat Water Main Plans Approved 12.16.20
12/21/2020 Letter INSPECTION SUMMARY
12/22/2020 Letter INSPECTION SUMMARY
12/28/2020 Letter INSPECTION SUMMARY
12/28/2020 Photograph CI C-10.jpg
12/28/2020 Photograph C-10 collar.jpg
12/28/2020 Photograph C-11.jpg
12/28/2020 Photograph C-12.jpg
01/11/2021 Letter INSPECTION SUMMARY
01/14/2021 Letter INSPECTION SUMMARY
01/19/2021 Photograph 54EE16C0-3F7B-4E92-A163-6FA9EEEC4F67.jpeg
01/19/2021 Photograph 60A3F2D4-07E1-4686-9AB2-DB9B7AFBF188.jpeg
01/19/2021 Photograph DF4418F2-5FE0-4665-8DBF-D26A944A79CF.jpeg
01/21/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
02/01/2021 Letter INSPECTION SUMMARY
02/01/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
02/02/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
02/23/2021 Letter INSPECTION SUMMARY
03/30/2021 Whispering Woods 2nd plat Water Samples 1
03/30/2021 Whispering Woods 2nd plat Water Samples 2
04/13/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter DE-Daily Inspection Summary
04/14/2021 Letter DE-Daily Inspection Summary
04/30/2021 Letter INSPECTION SUMMARY
05/01/2021 Letter INSPECTION SUMMARY
05/03/2021 Letter INSPECTION SUMMARY
07/22/2021 Plans Not approved As Built Master Drainage Plan Whispering Woods 2nd-Signed
09/28/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
09/28/2021 Letter DE-Punch List
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
09/28/2021 Letter INSPECTION SUMMARY
10/05/2021 Plans Whispering Woods 2nd Sanitary
11/05/2021 Plans Whispering Woods 2nd Water Asbuilt
11/05/2021 Plans Whispering Woods 2nd Storm Asbuilt
11/17/2021 Plans Whispering Woods 2nd Sanitary Asbuilt
11/17/2021 Plans Whispering Woods 2nd Water Asbuilt
11/17/2021 Plans Whispering Woods 2nd Storm Asbuilt
08/07/2023 Security Document Whispering Woods 2nd Bond Affidavit
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
