Permit Application Status

PRSUBD20201877

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSUBD20201877
Public Infrastructure
Final Acceptance
SILVERSTONE DEVELOPMENT LLC
DEVELOPMENT COMPLETE
MONTICELLO 4TH PLAT - WATER AND SANITARY, ESC, STREET AND STORM
07/08/2020
08/13/2020
05/27/2024
03/02/2022
Locations
Address
4705 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4709 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4713 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4717 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4721 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4725 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4729 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4733 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4805 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4809 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4813 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4817 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4821 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4824 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4820 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4816 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4812 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4808 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4805 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4809 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4813 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4821 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4816 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4808 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4804 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4736 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4732 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4728 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4724 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4720 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4716 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4709 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4713 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4717 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4721 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4729 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4737 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Address
4732 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4728 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4724 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4720 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4716 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4708 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4817 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4812 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4737 NE FREEHOLD DR, LEES SUMMIT, MO 64064

Address
4801 NE FREEHOLD CT, LEES SUMMIT, MO 64064

Address
4740 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Property
43130065000000000

Property
43130065100000000

Property
43130065200000000

Property
43130065300000000

Property
43130065400000000

Property
43130065500000000

Property
43130065600000000

Property
43130065700000000

Property
43130065900000000

Property
43130066000000000

Property
43130066100000000

Property
43130066200000000

Property
43130066300000000

Property
43130050500000000

Property
43130050600000000

Property
43130050700000000

Property
43130050800000000

Property
43130050900000000

Property
43130051000000000

Property
43130051100000000

Property
43130051200000000

Property
43130051300000000

Property
43130051500000000

Property
43130051600000000

Property
43130051800000000

Property
43130051900000000

Property
43130052000000000

Property
43130052100000000

Property
43130052200000000

Property
43130052300000000

Property
43130052400000000

Property
43130052500000000

Property
43130052600000000

Property
43130041500000000

Property
43130041400000000

Property
43130041300000000

Property
43130041200000000

Property
43130041100000000

Property
43130041000000000

Property
43130040900000000

Property
43130040800000000

Property
43130040700000000

Property
43130040600000000

Property
43130040500000000

Property
43130040400000000

Property
43130051400000000

Property
43130051700000000

Property
43130065800000000

Property
43130052700000000

Address
4712 NE JAMESTOWN DR, LEES SUMMIT, MO 64064

Contacts
SILVERSTONE DEVELOPMENT LLC, Address:PO BOX 346
ENGINEERING SOLUTIONS, Address:50 SE 30TH ST, Phone:(816) 623-9888
BELLAH HOMES LLC, Address:P O BOX 346, Phone:(816) 697-2870
NZC HOMES LLC, Address:1009 INDUSTRIAL DR
WILSON MEGAN & ROD, Address:4713 NE FREEHOLD DR
SCHUSTER ABBIE, Address:4717 NE FREEHOLD DR
GOODSON JEFFREY R & MELANIE L, Address:4721 NE FREEHOLD DR
JOHNSON KRISOFER & CARLYN, Address:4725 NE FREEHOLD DR
COSTANZA JOHN A & NICOLETTE L, Address:4729 NE FREEHOLD DR
SIMPSON BOBBIE, Address:4733 NE FREEHOLD DR
MOORE CHRISTOPHER ALAN & WENDY LEE, Address:4824 NE JAMESTOWN DR
TAYLOR JAMES & TANESHA, Address:4820 NE JAMESTOWN DR
KRUGER NANCY R, Address:4816 NE JAMESTOWN DR
PENNELL ROBERT R & JACQUELINE A, Address:4812 NE JAMESTOWN DR
REHMSMEYER ROBERT & JAIME, Address:4808 NE JAMESTOWN DR
SCHYVINCK FAMILY TRUST DATED JANUARY 8, 2021, Address:4805 NE FREEHOLD CT
C & C HOME 2024 LLC, Address:4512 NE HIDEAWAY HILL CIR
BRAD & MARY GREGORY REVOCABLE TRUST DATED 05/09/2023, Address:28442 ALTESSA WAY #202
LUETHJE RYAN B & JOHANNA R, Address:4816 NE FREEHOLD CT
STICHKA BRENT J & GERALDINE L, Address:4808 NE FREEHOLD CT
BENJAMIN JOSEPH DUVALL IRREVOCABLE TRUST DATED 7-12-2012, Address:4804 NE FREEHOLD CT
PARIS LIVING TRUST DATED 06/24/2024, Address:4736 NE JAMESTOWN DR
DO VIET Q, Address:4732 NE JAMESTOWN DR
TRENTON THURMON & GRESKO KATELYN, Address:4728 NE JAMESTOWN DR
LAWRENCE JORDAN & ASHLEY, Address:4724 NE JAMESTOWN DR
BURSON JAMES D & EVA W, Address:4720 NE JAMESTOWN DR
STACKHOUSE JAMILLAH & MICHAEL C, Address:4716 NE JAMESTOWN DR
LE THOANG, Address:4709 NE JAMESTOWN DR
DAVE RICHARDS HOME BUILDING LLC, Address:4713 NE JAMESTOWN DR
GOUGH TETH A & SONYA A, Address:4717 NE JAMESTOWN DR
GUERRERO DUBERT M & ROANNE D, Address:4721 NE JAMESTOWN DR
MERRIMAN STEVEN M & JANNA FOX, Address:4729 NE JAMESTOWN DR
PARRISH CARISA & ABRAHAM JOHN, Address:4737 NE JAMESTOWN DR
HARRISON KIMBERLY & BRYON, Address:4732 NE FREEHOLD DR
LASSITER BRANDON & SOMMER, Address:4728 NE FREEHOLD DR
CHRISTOPHER R BINNS & SIERRA L BINNS REVOCABLE LIVING TRAUS DATE 6-27-2024, Address:4724 NE FREEHOLD DR
FUQUA-HOWARD PRESTON & MEGAN, Address:4720 NE FREEHOLD DR
BENNETT JOINT REVOCABLE TRUST DATED 06/09/2021, Address:4716 NE FREEHOLD DR
BEALE DONALD E & DEBORA K, Address:4708 NE FREEHOLD DR
MONTICELLO PROPERTY OWNERS ASSOCIATION INC, Address:PO BOX 346
GOINS RICHARD L & KELLLY M, Address:4801 NE FREEHOLD CT
EDWARD AND TRACY KING TRUST DATED 11-21-2013, Address:4740 NE JAMESTOWN DR
BANNING WILLIAM M & LESLIE, Address:4805 NE JAMESTOWN DR
KILDUFF ZACHARY M & KELLY M, Address:4809 NE JAMESTOWN DR
RIGGINS ZACHARY G & CAITLIN, Address:4813 NE JAMESTOWN DR
WORLEY JASON & MICHELLE, Address:4817 NE JAMESTOWN DR
ROSS SARAH, Address:4821 NE JAMESTOWN DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 07/08/2020 08/13/2020
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 08/07/2020
91100C9-Water Insp Fee $3,320.35 $3,320.35 Paid 08/07/2020
9110072-Water Test Fee $600.00 $600.00 Paid 08/07/2020
91100C8-Sanitary Sewer Insp Fees $3,381.05 $3,381.05 Paid 08/07/2020
9110068-Storm Fee $5,518.18 $5,518.18 Paid 08/07/2020

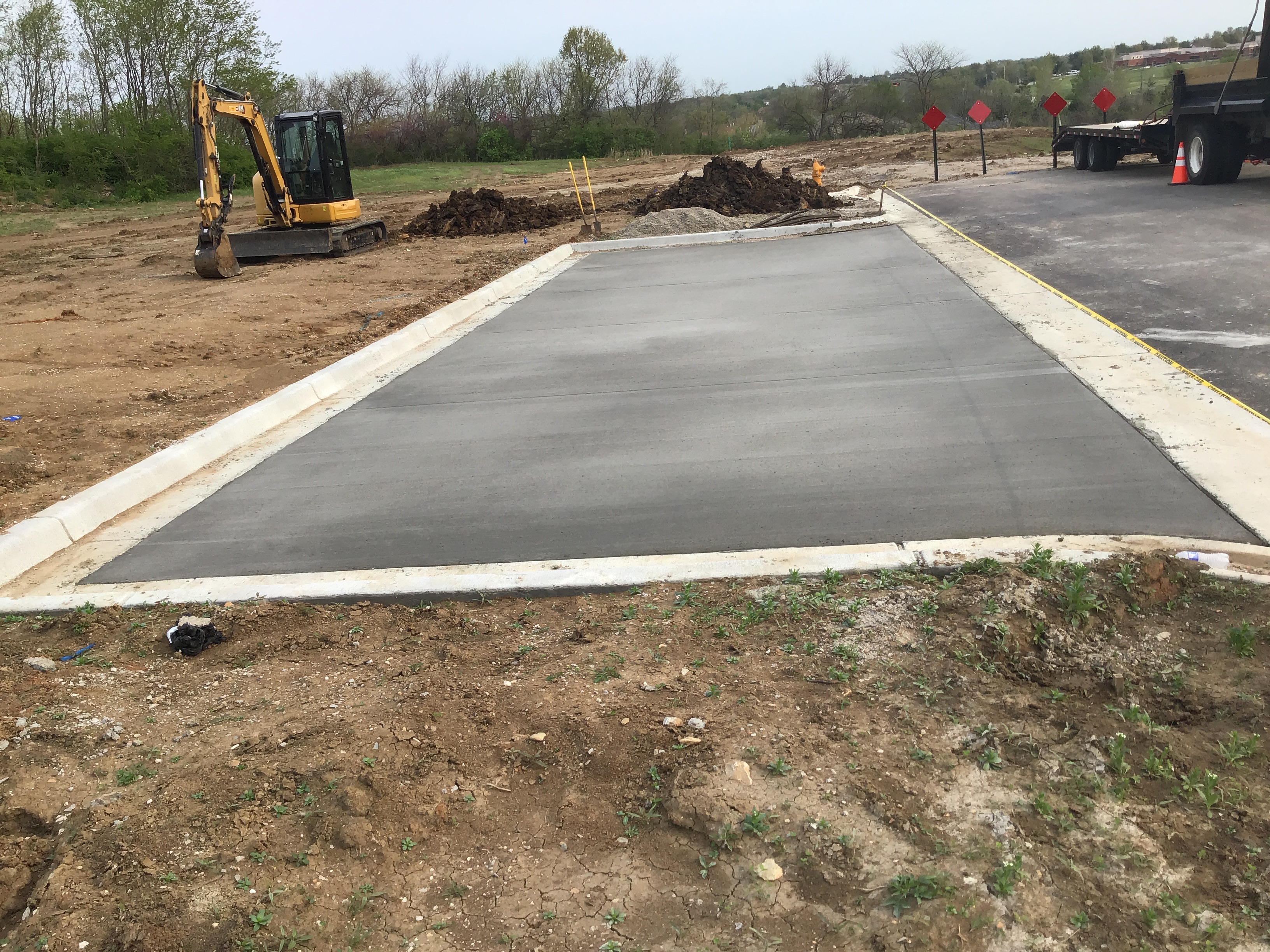

9110081-Paved Surface Inspection Fee $13,201.85 $13,201.85 Paid 08/07/2020

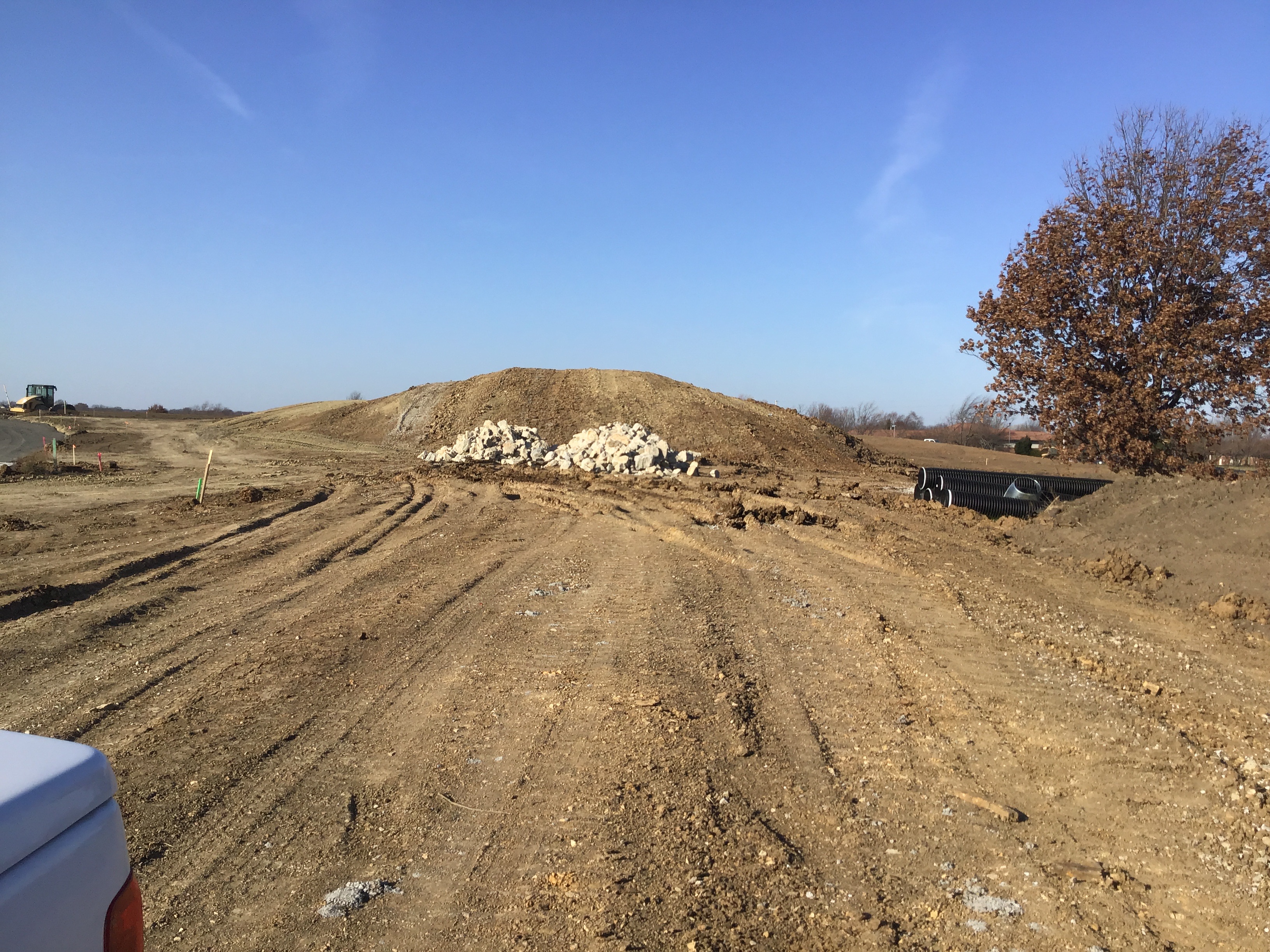

9110071-Site Grading Fee $8,121.92 $8,121.92 Paid 08/07/2020
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $595.00 $0.00 $595.00 Not Paid
9110080-Not Ready Inspection Fee $50.00 $0.00 $50.00 Not Paid

$645.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected

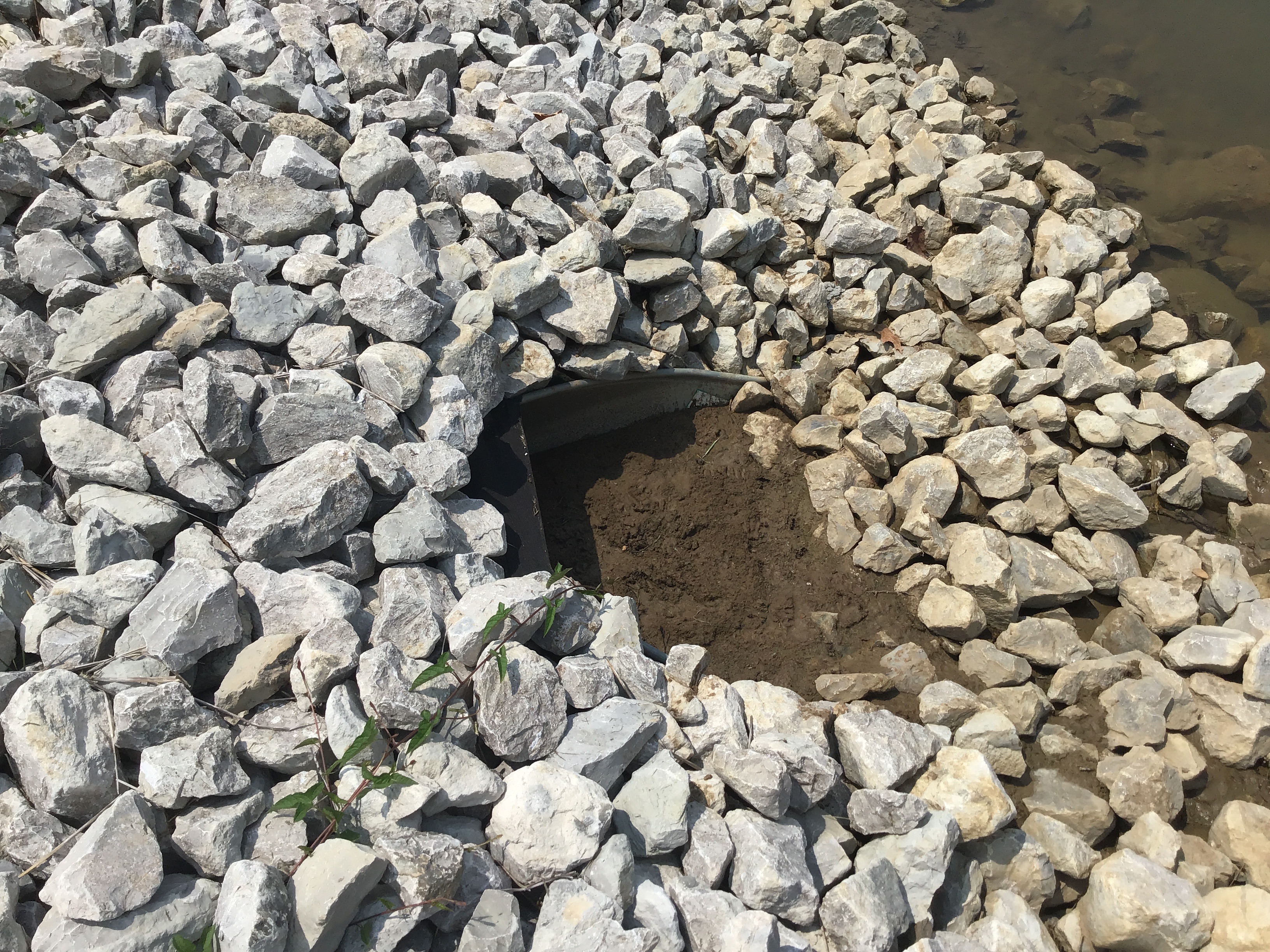

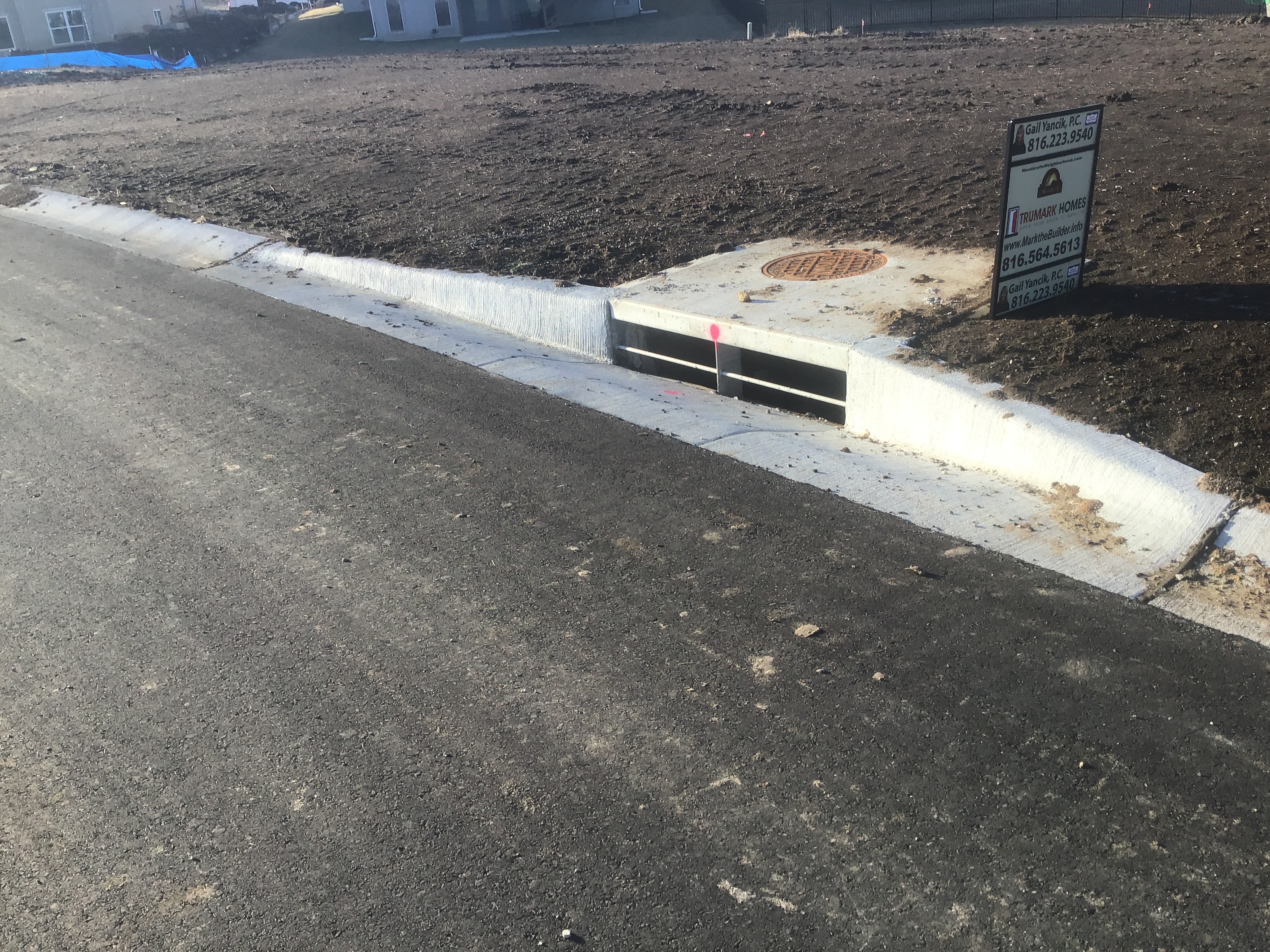

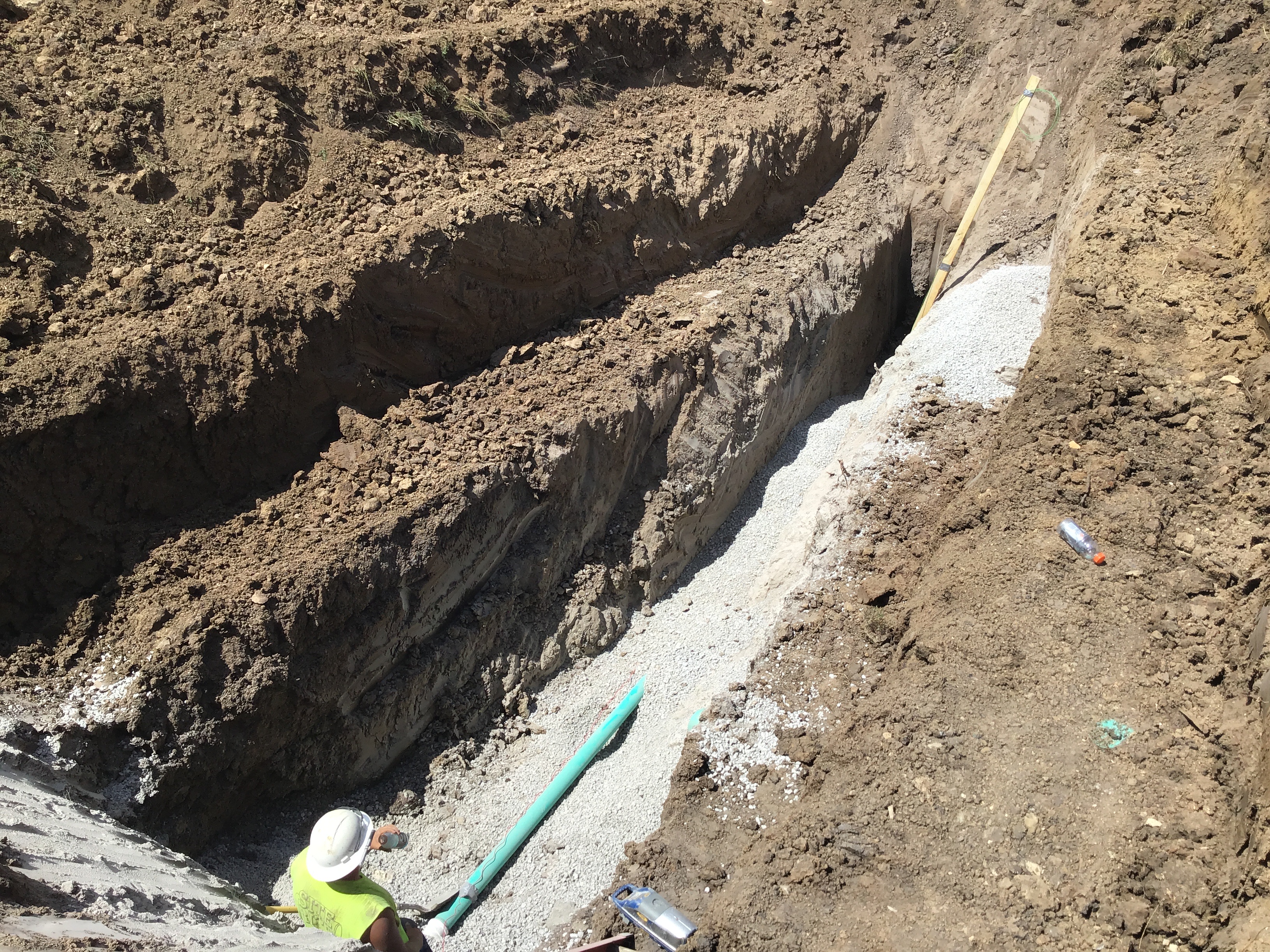

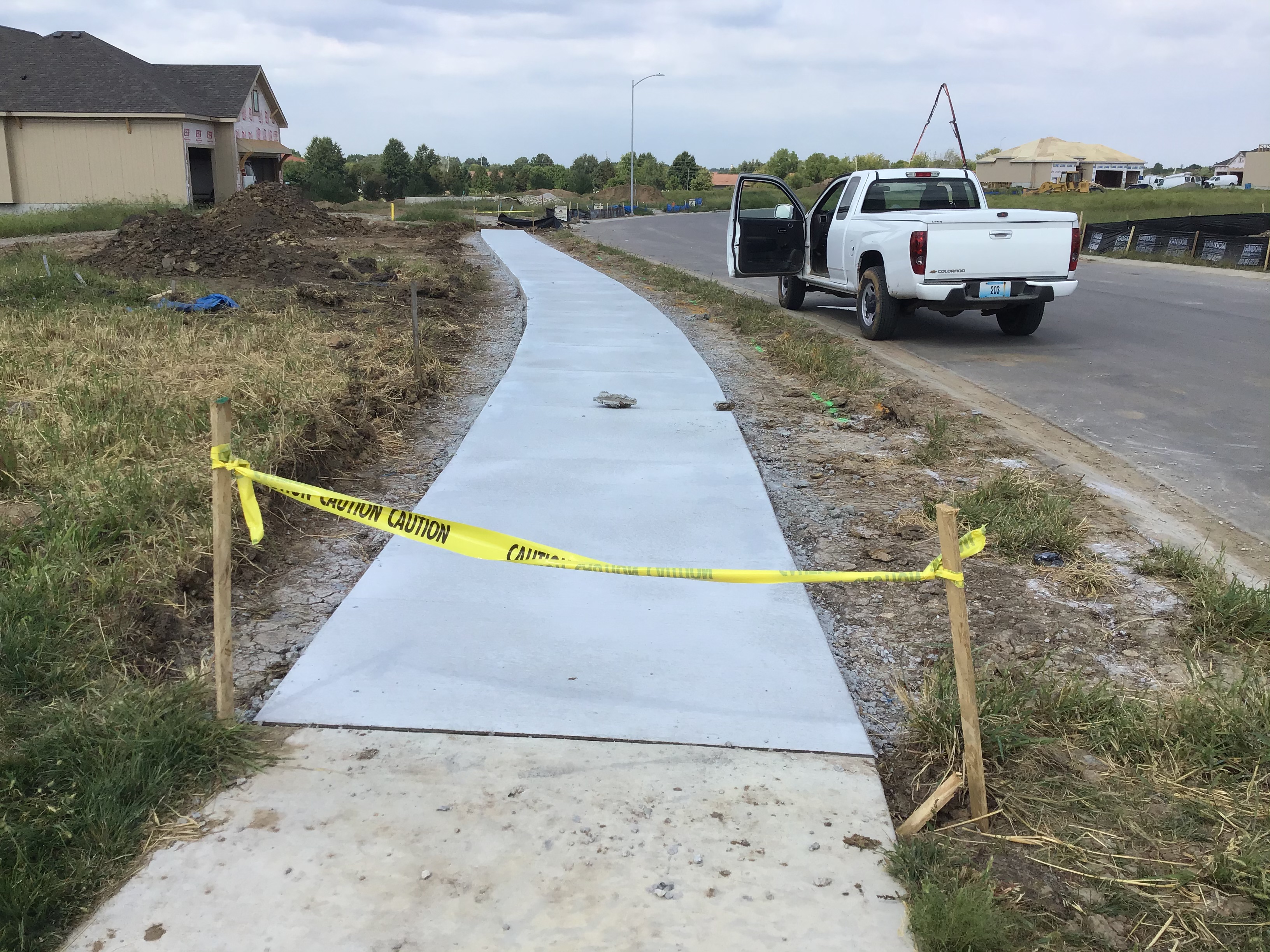

Erosion Control Inspection Partial 08/18/2020
Misc
Informational
08/18/2020

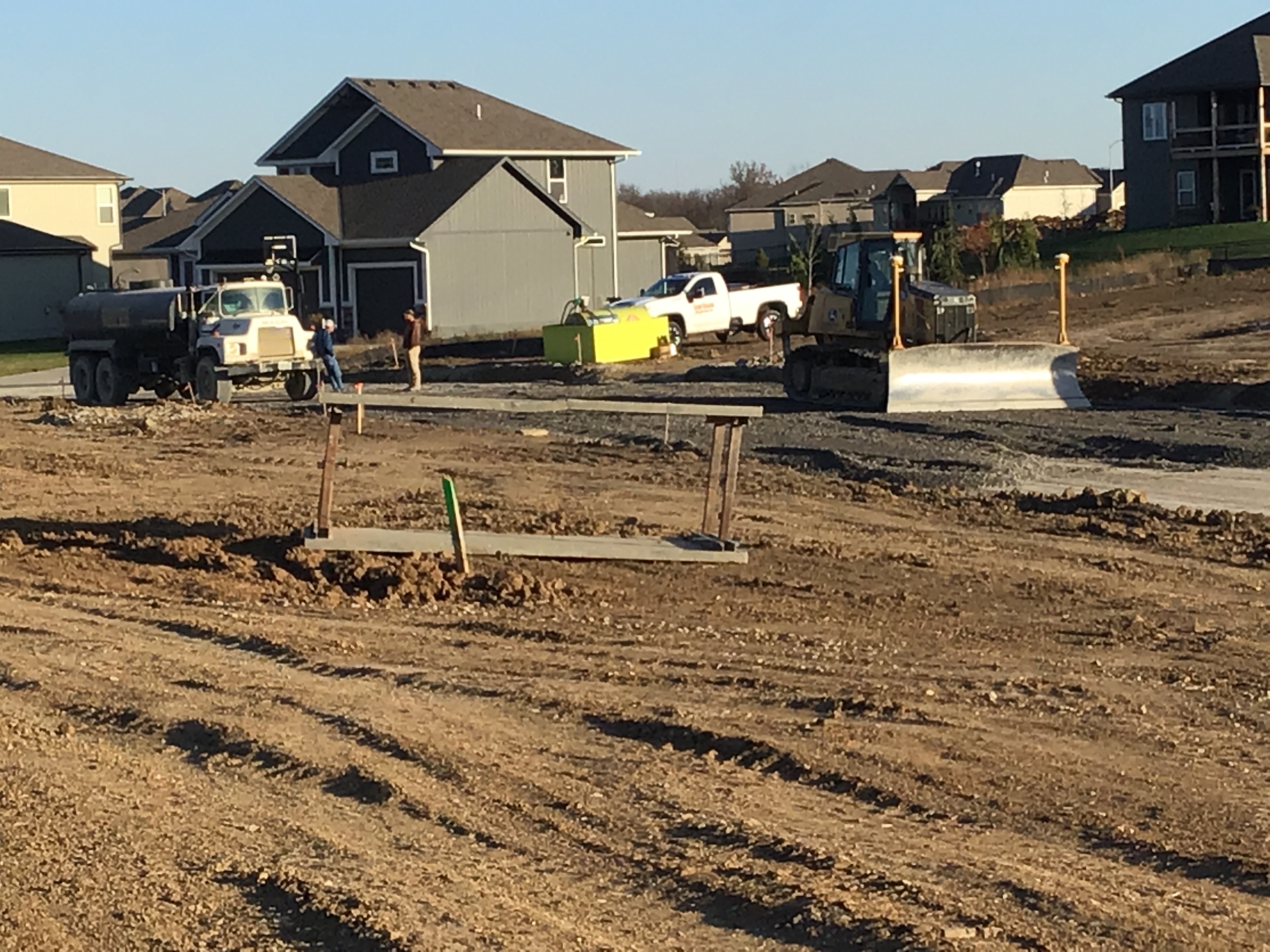

8/17/20 Monday Silt Fence appeared to be properly installed work site. I will continue to monitor silt fence to ensure it maintain its effectiveness.

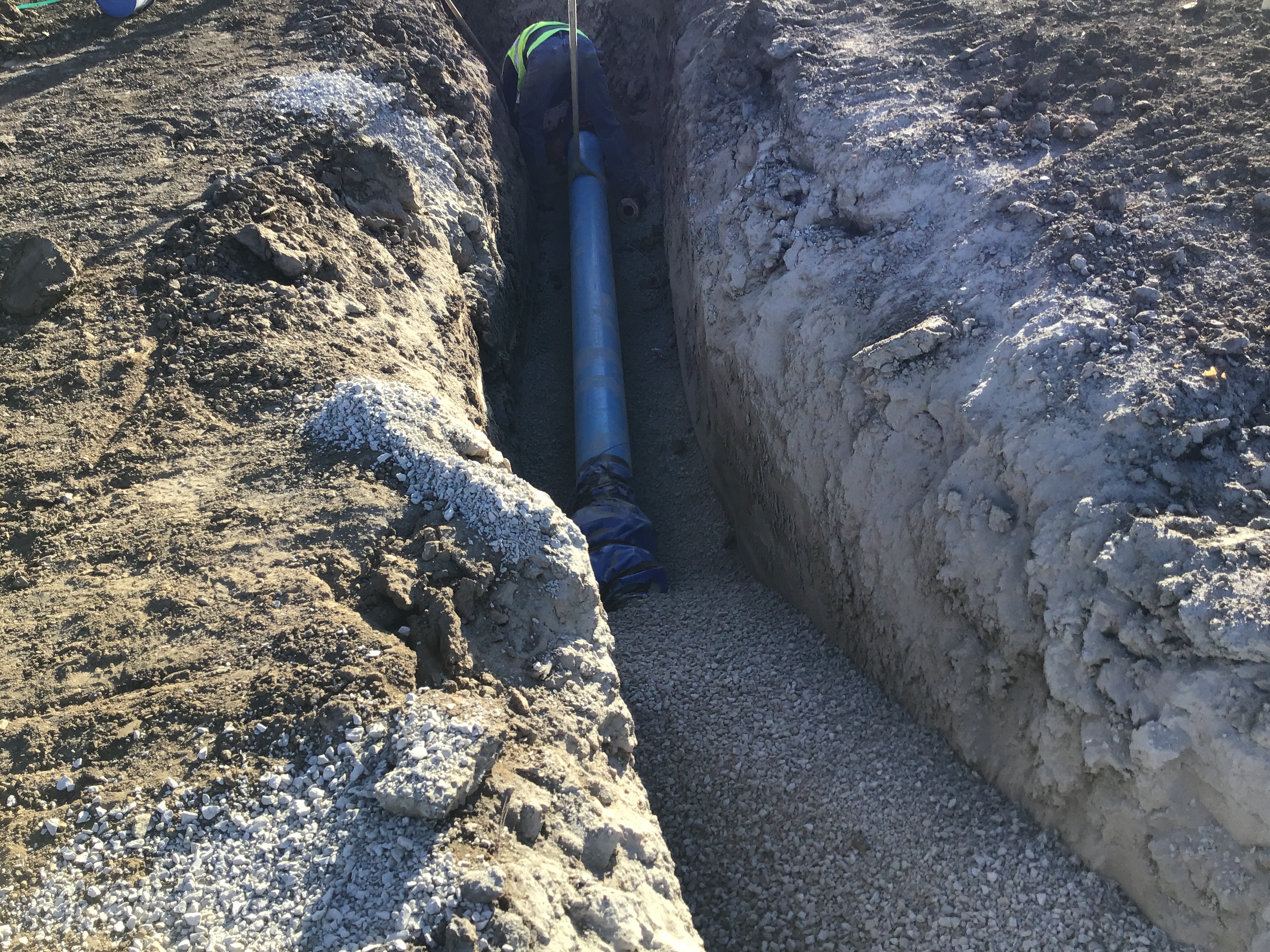

Sanitary Sewer Construction Inspection Partial 08/27/2020
Misc
Informational
08/27/2020

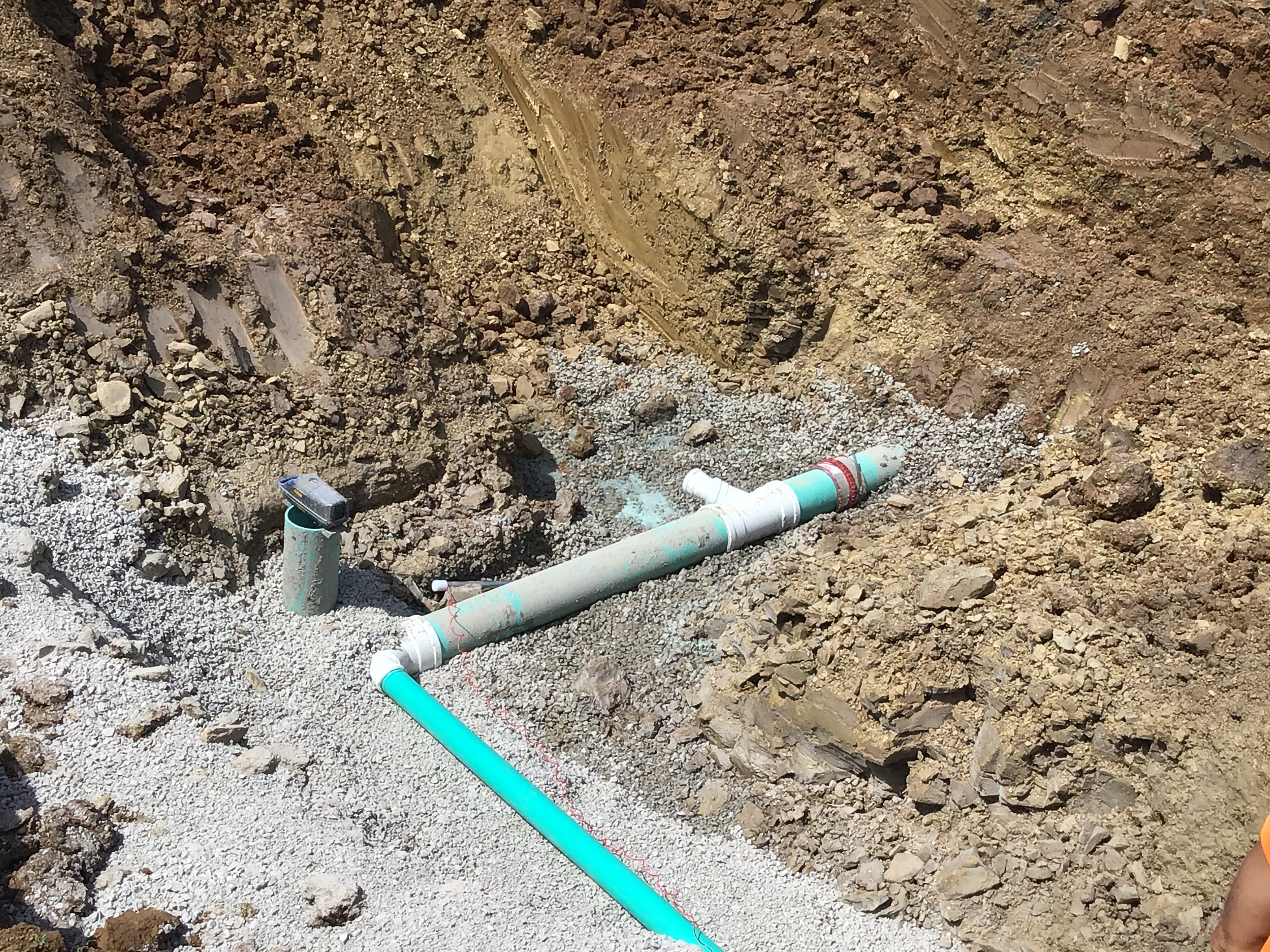

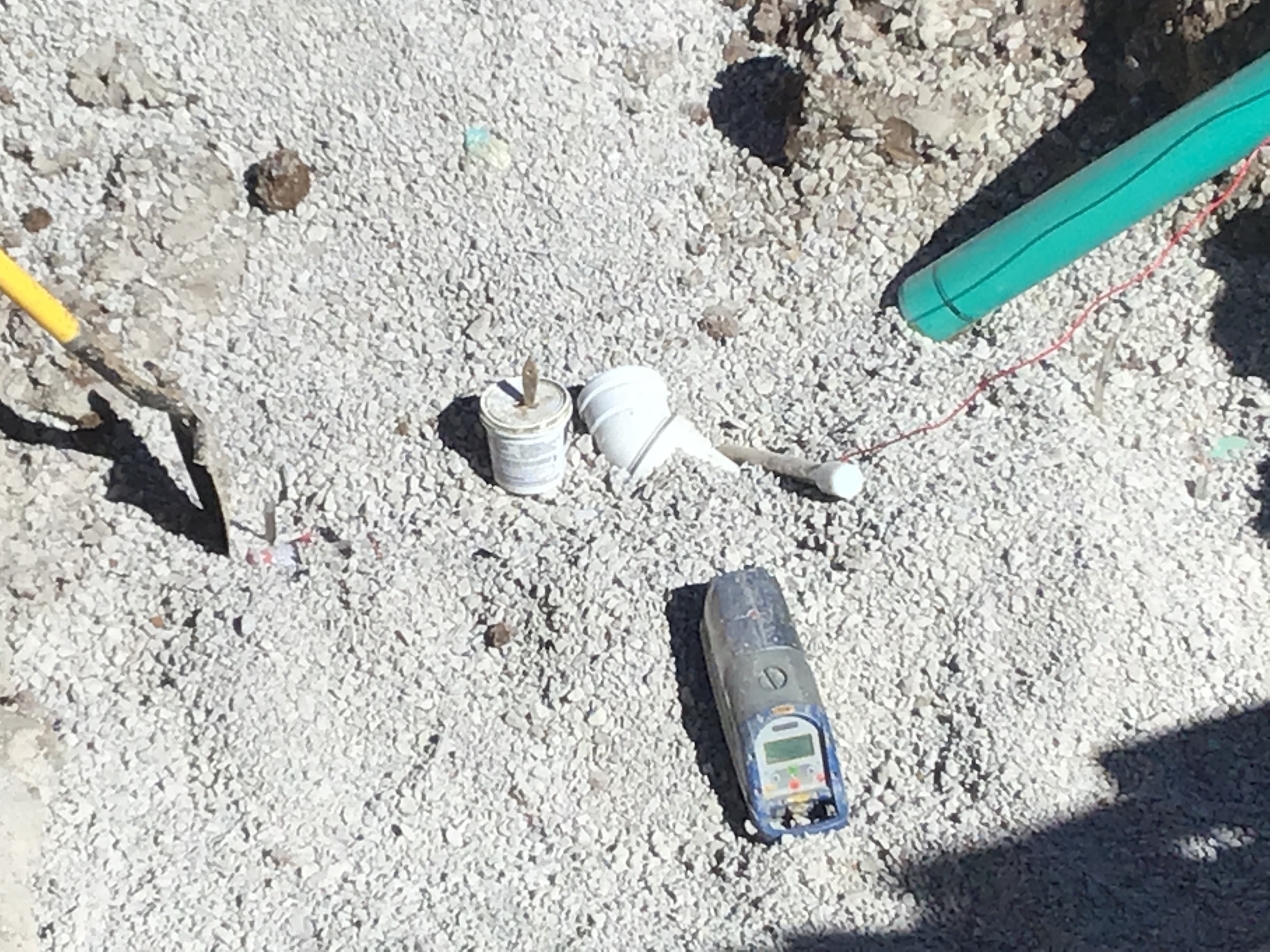

8/27/20 Thursday 9:00 AM Two 8” Maxadaptors and 8”x4”wye were installed on existing sanitary Line C. Lots 125, 124, & 123 laterals with the same setup cutting into the existing sanitary Line C.

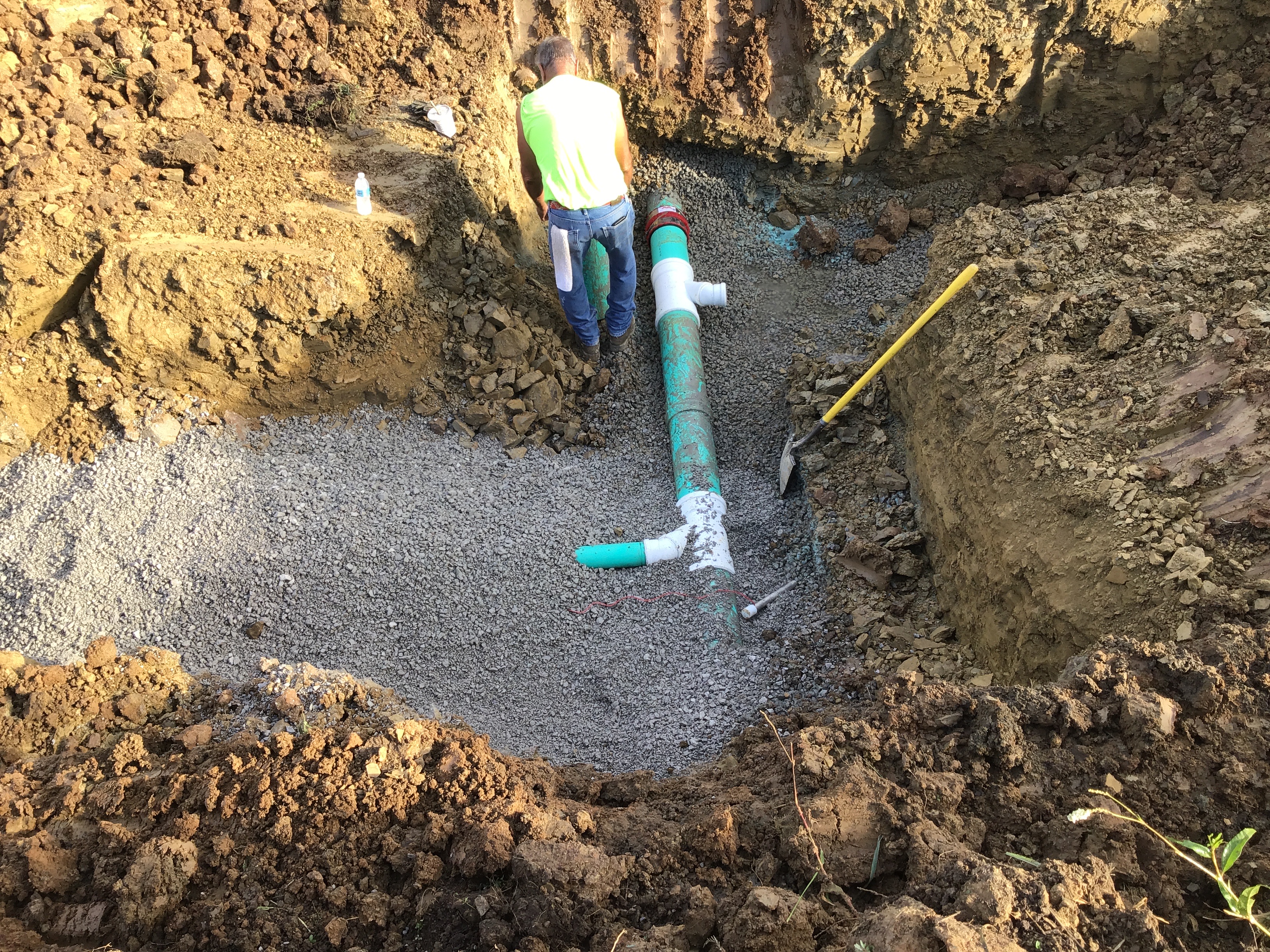

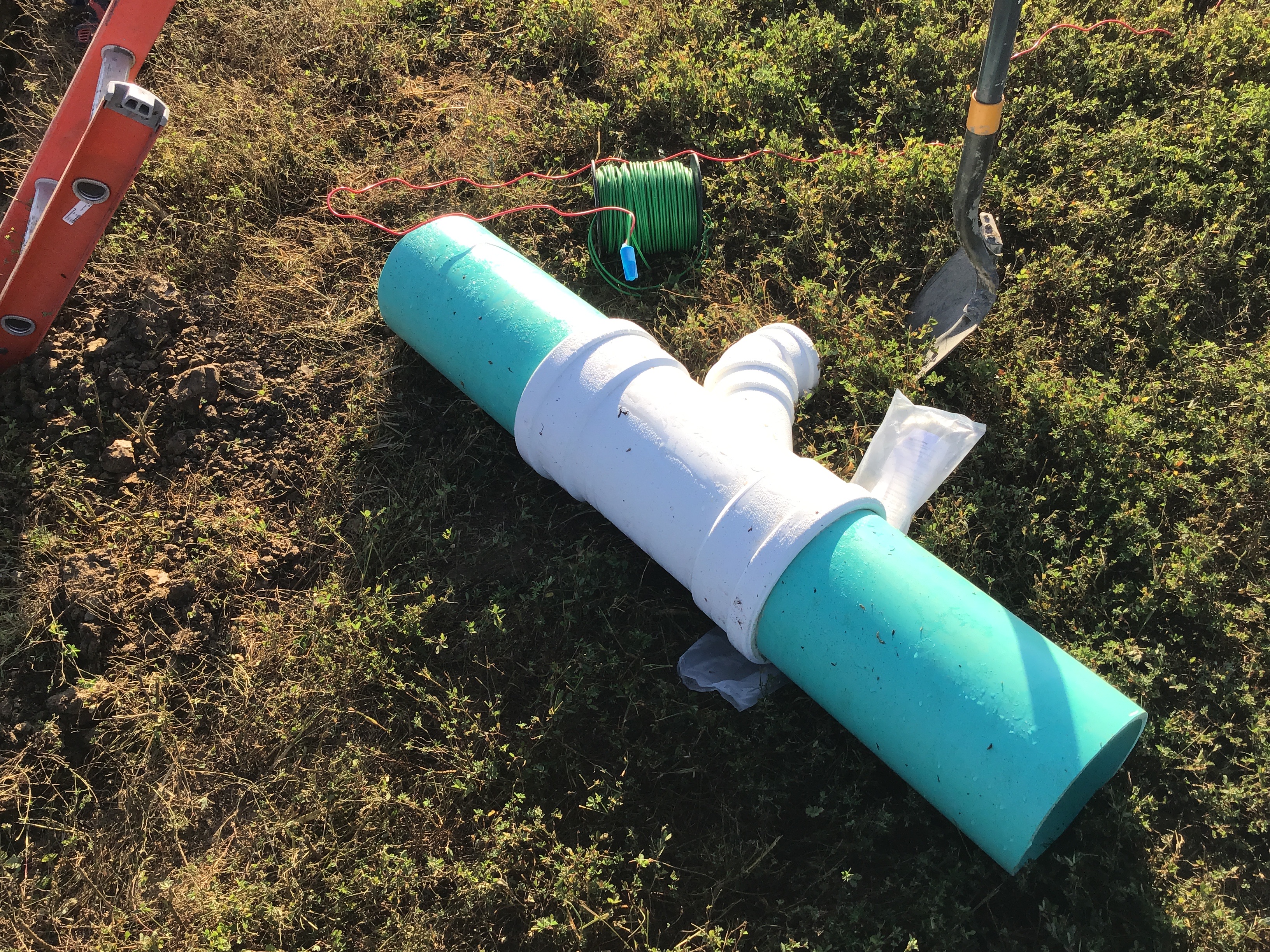

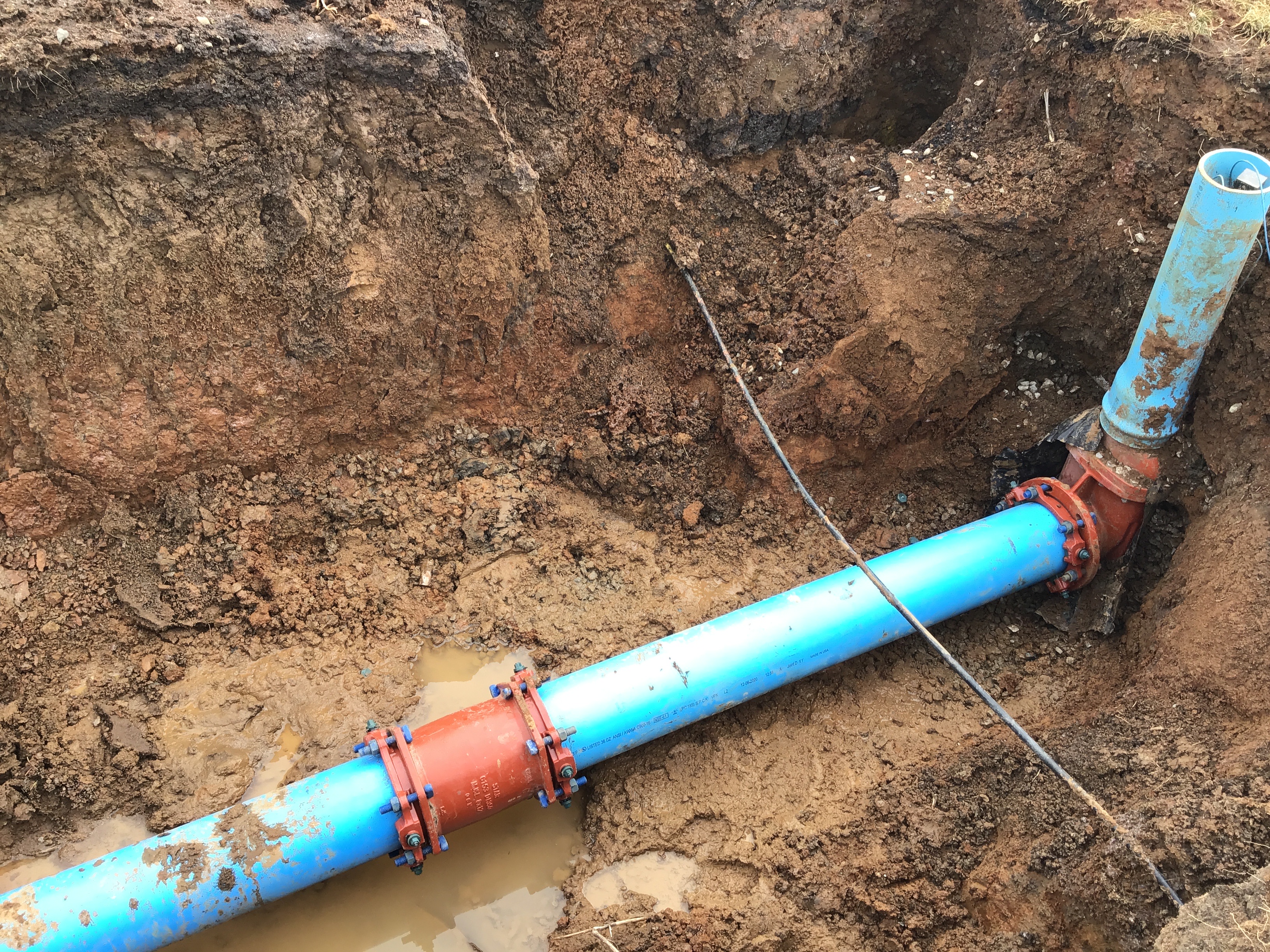

Water - Material Verification Partial 08/27/2020
Misc
Informational
08/27/2020

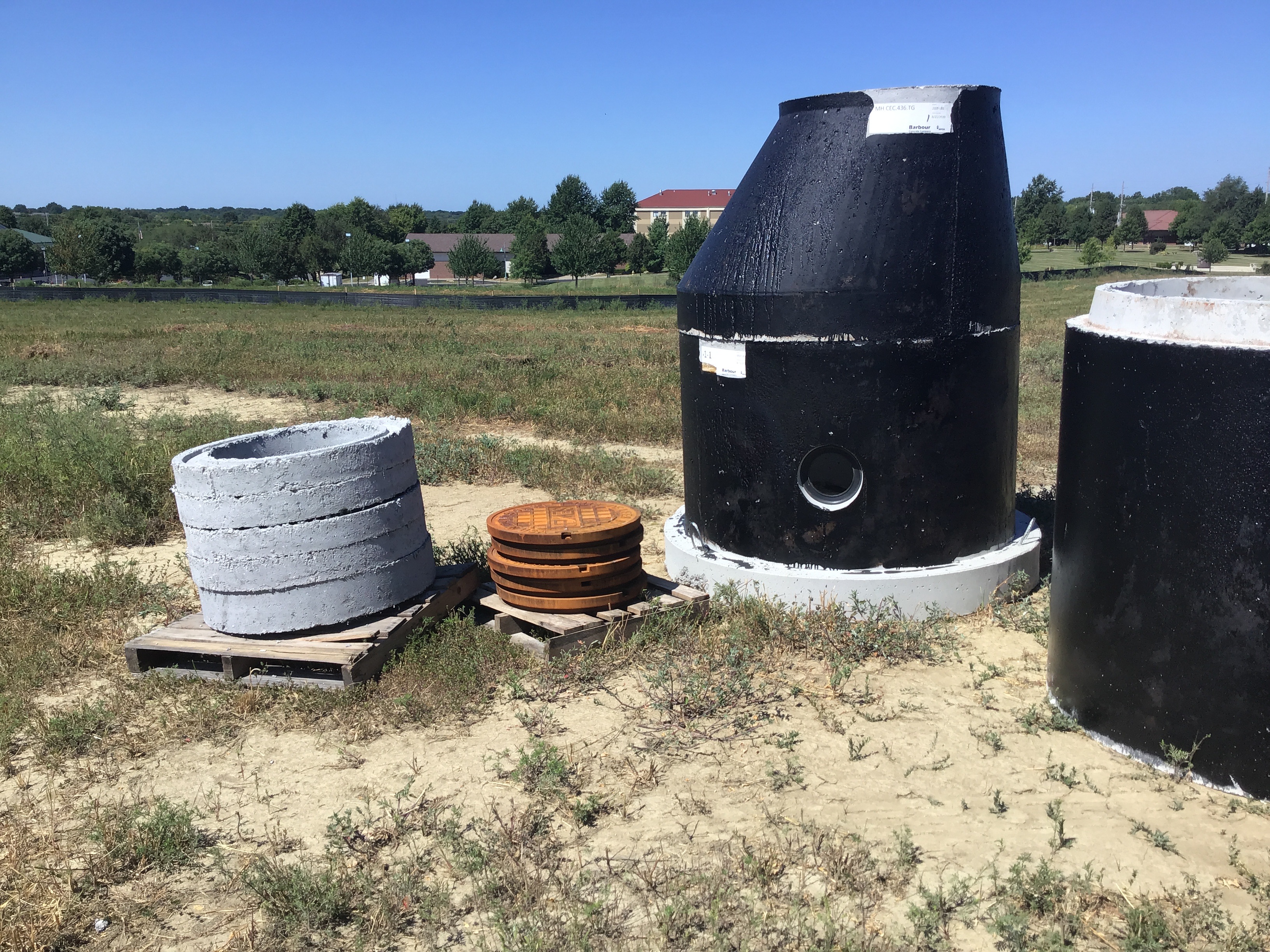

8/27/20 Thursday Verified Sanitary Manholes, metal and concrete extension rings and lids. See documents. Note placed in the wrong location.

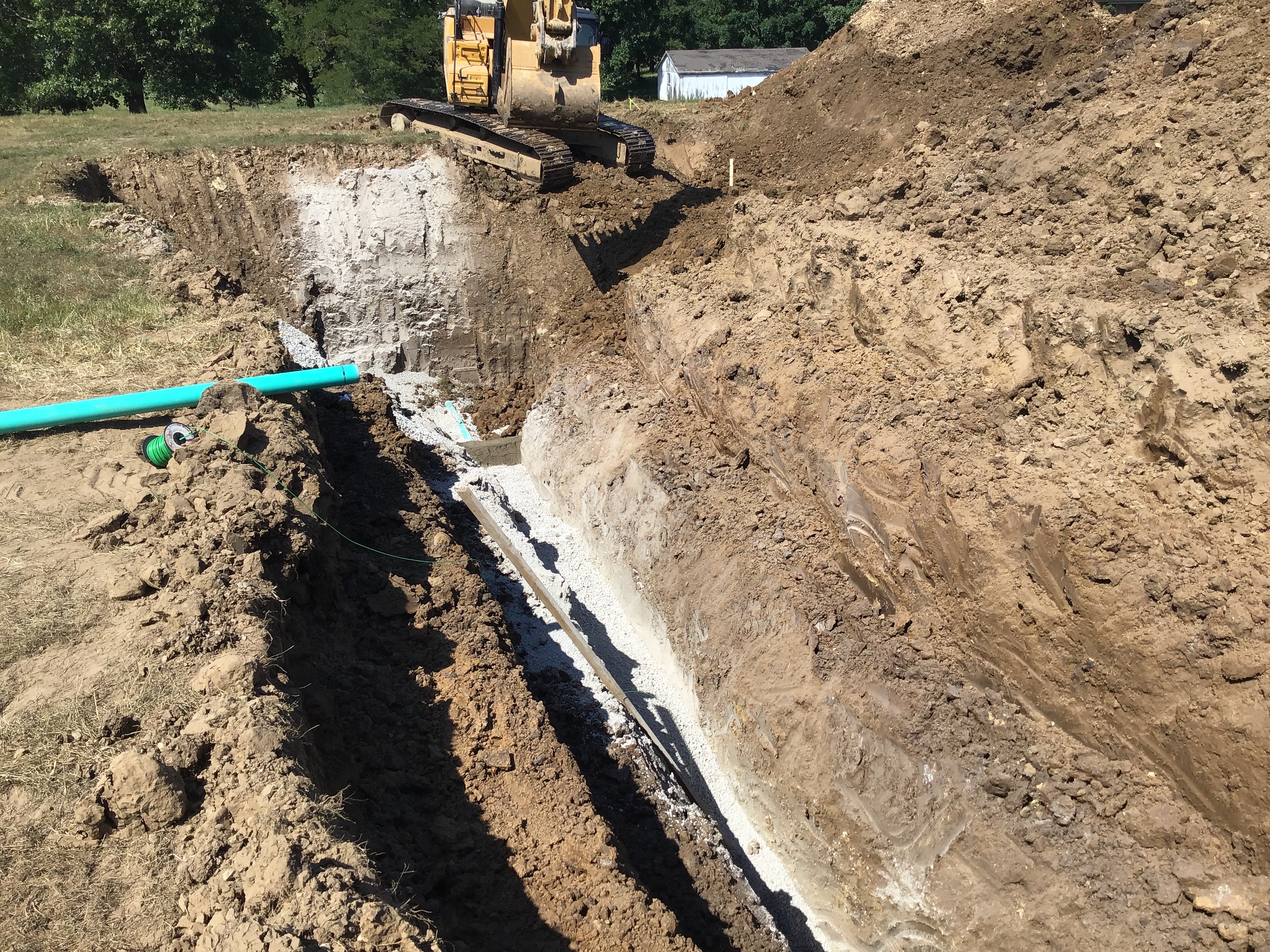

Sanitary Sewer Construction Inspection Partial 08/28/2020
Misc
Informational
08/27/2020

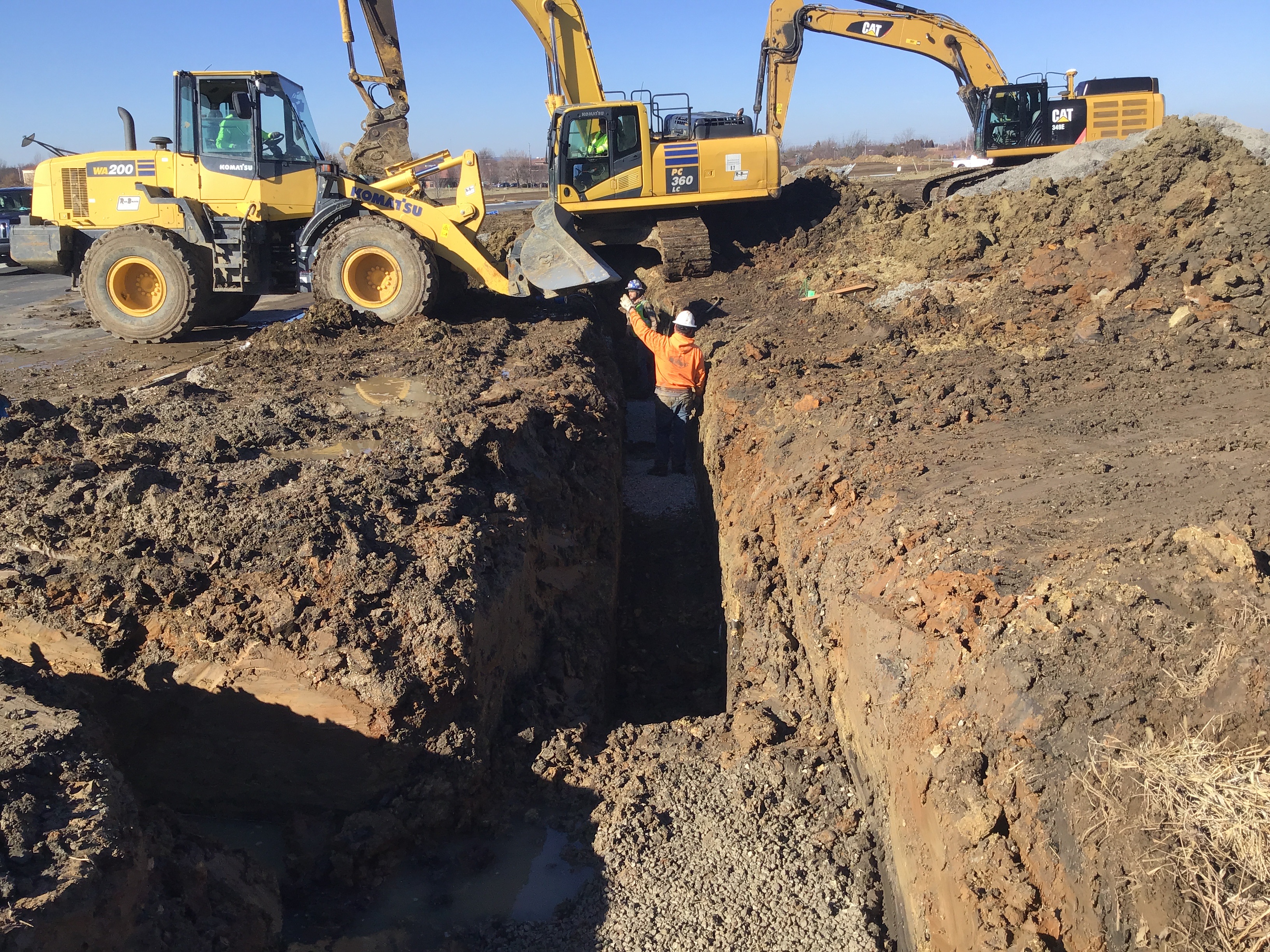

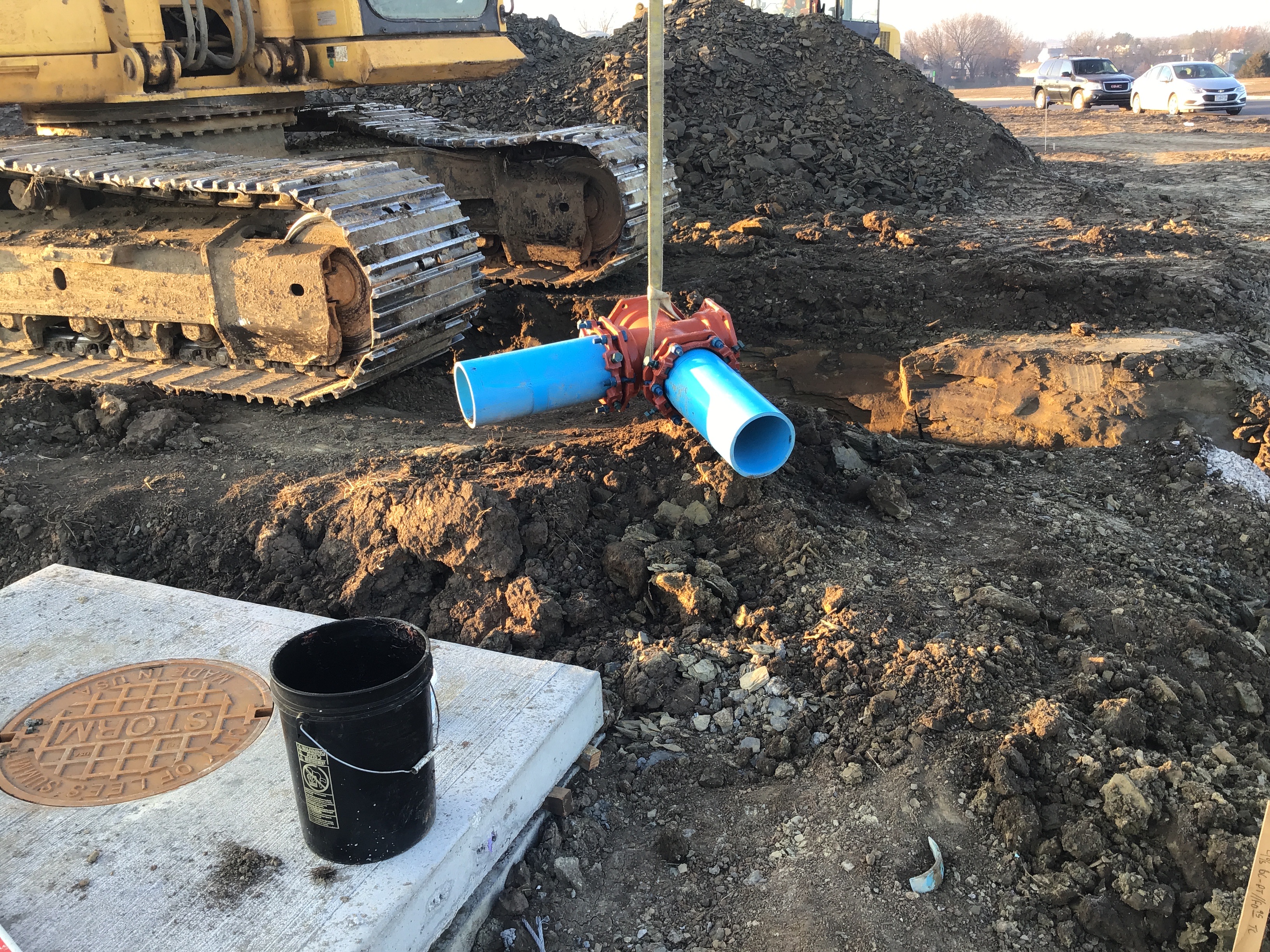

8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wyes in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 123. Contractor excavated Lot 122 & 120 and install 8“X4” wye with the two Maxadaptor couplings. Ditch checks were poured on lateral lines.

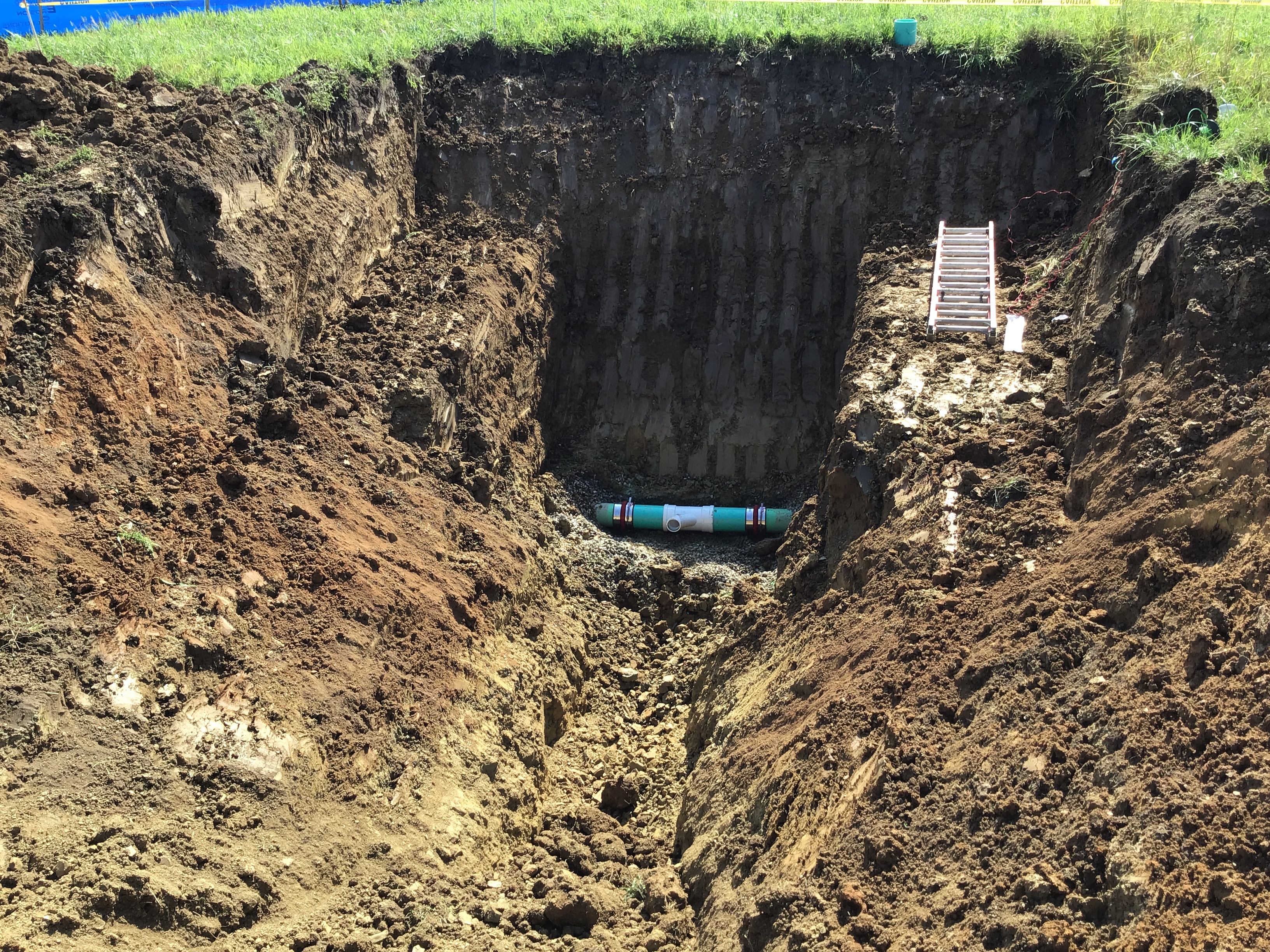

Sanitary Sewer Construction Inspection Partial 09/02/2020
Misc
Informational
08/28/2020

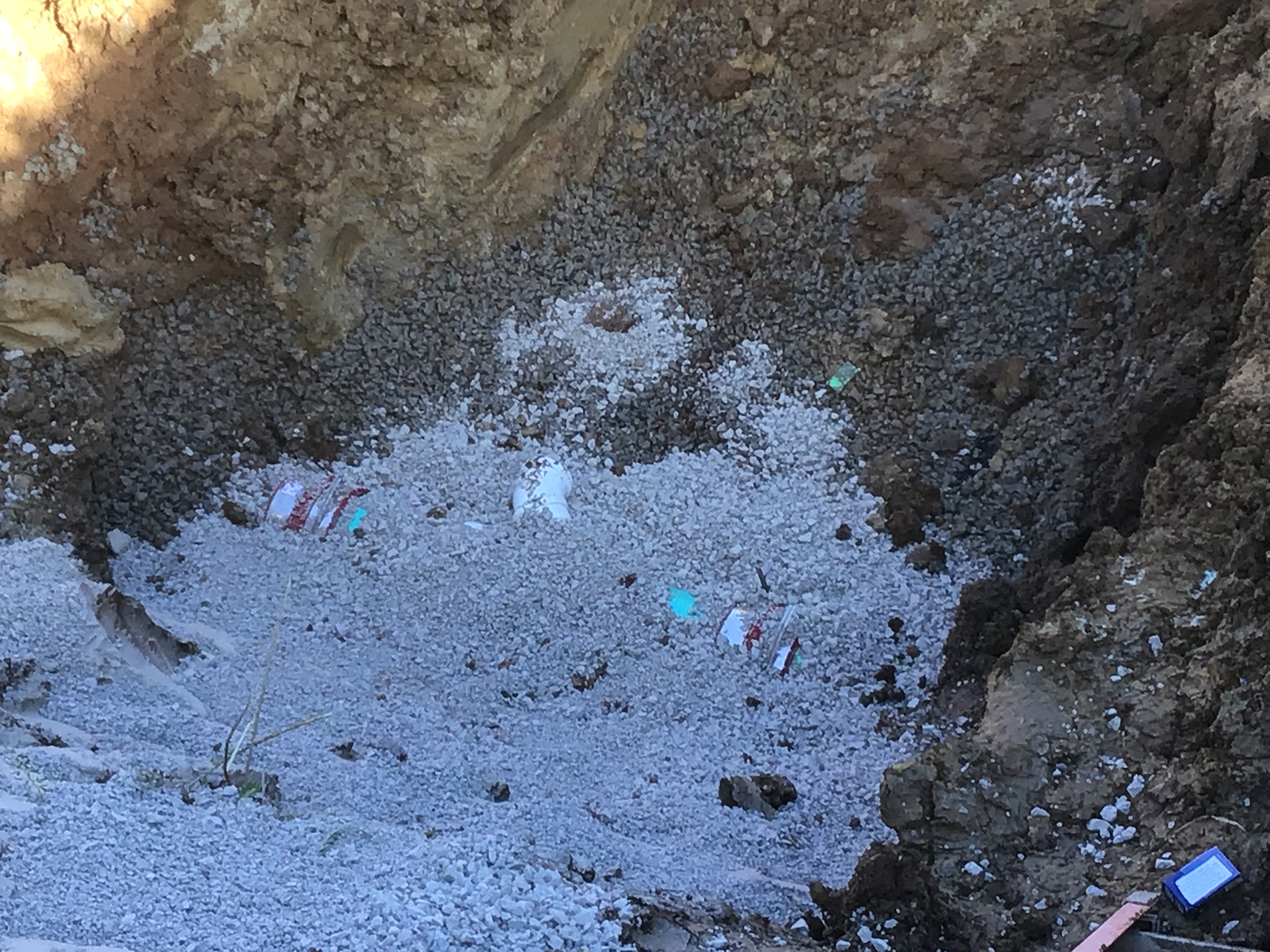

8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/02/2020

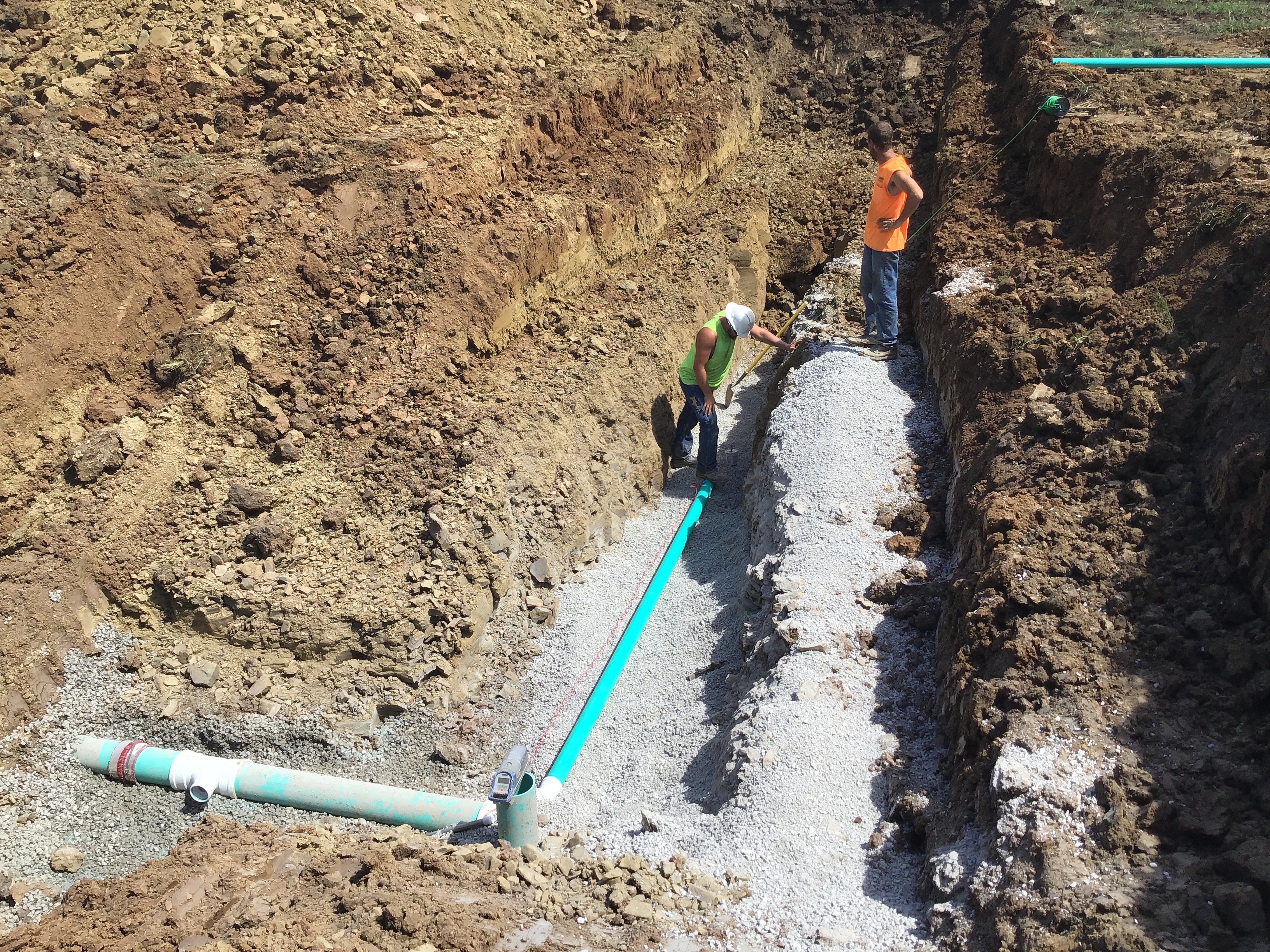

9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 147 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Sanitary Sewer Construction Inspection Partial 09/03/2020
Misc
Informational
09/02/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/02/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/03/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140. Lots 141, & 144 had wyes and laterals installed and Lot 143 wye was installed.
Sanitary Sewer Construction Inspection Partial 09/04/2020
Misc
Informational
09/03/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/03/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/03/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/04/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Sanitary Sewer Construction Inspection Partial 09/09/2020
Misc
Informational
09/04/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/04/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/04/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/04/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/09/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor completed lateral on working on Lot 119 and 135 and Maxadaptor.
Sanitary Sewer Construction Inspection Partial 09/15/2020
Misc
Informational
09/09/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/09/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/09/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/09/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/09/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/15/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Sanitary Sewer Construction Inspection Partial 09/15/2020
Misc
Informational
09/15/2020

8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/15/2020

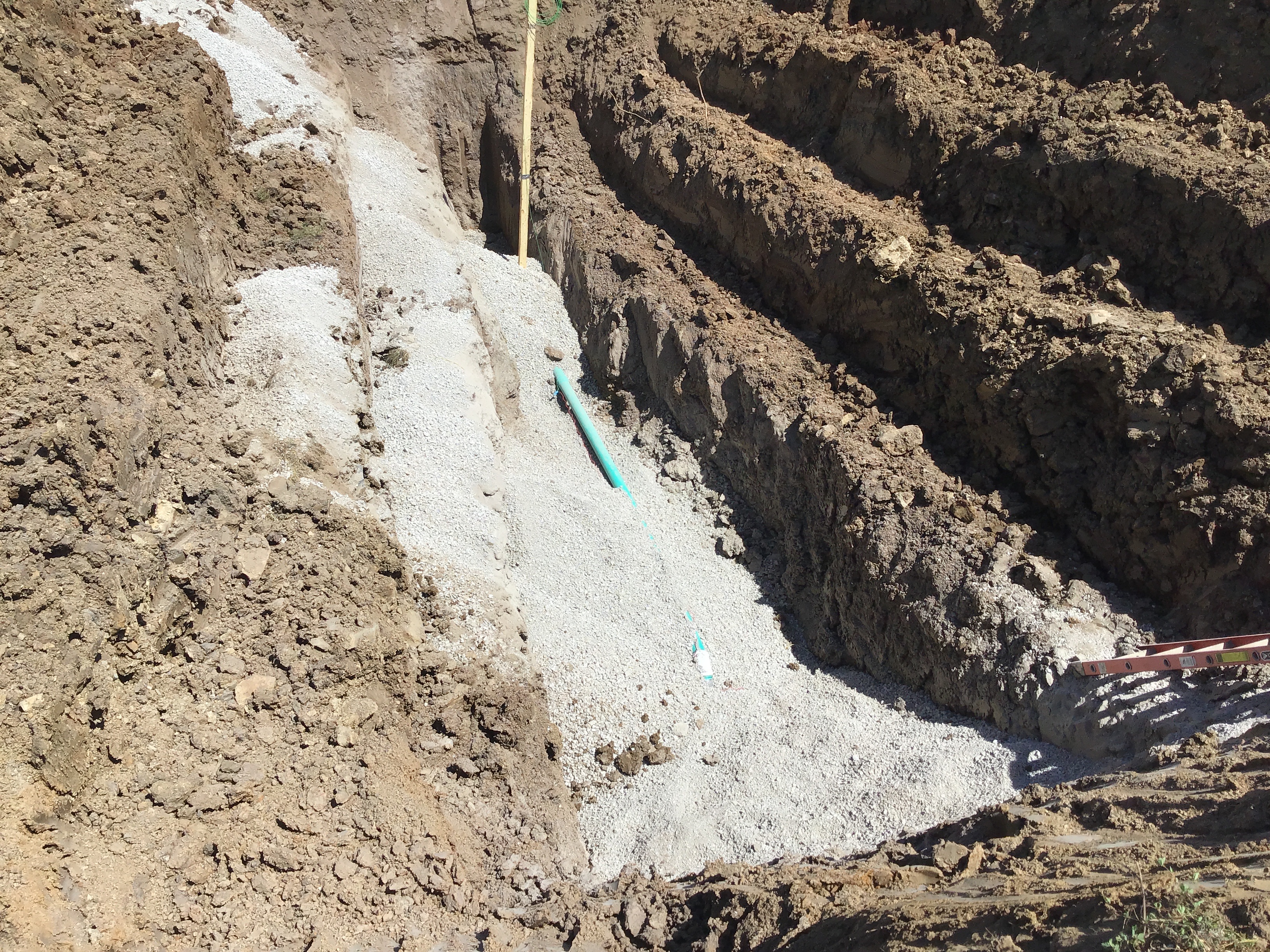

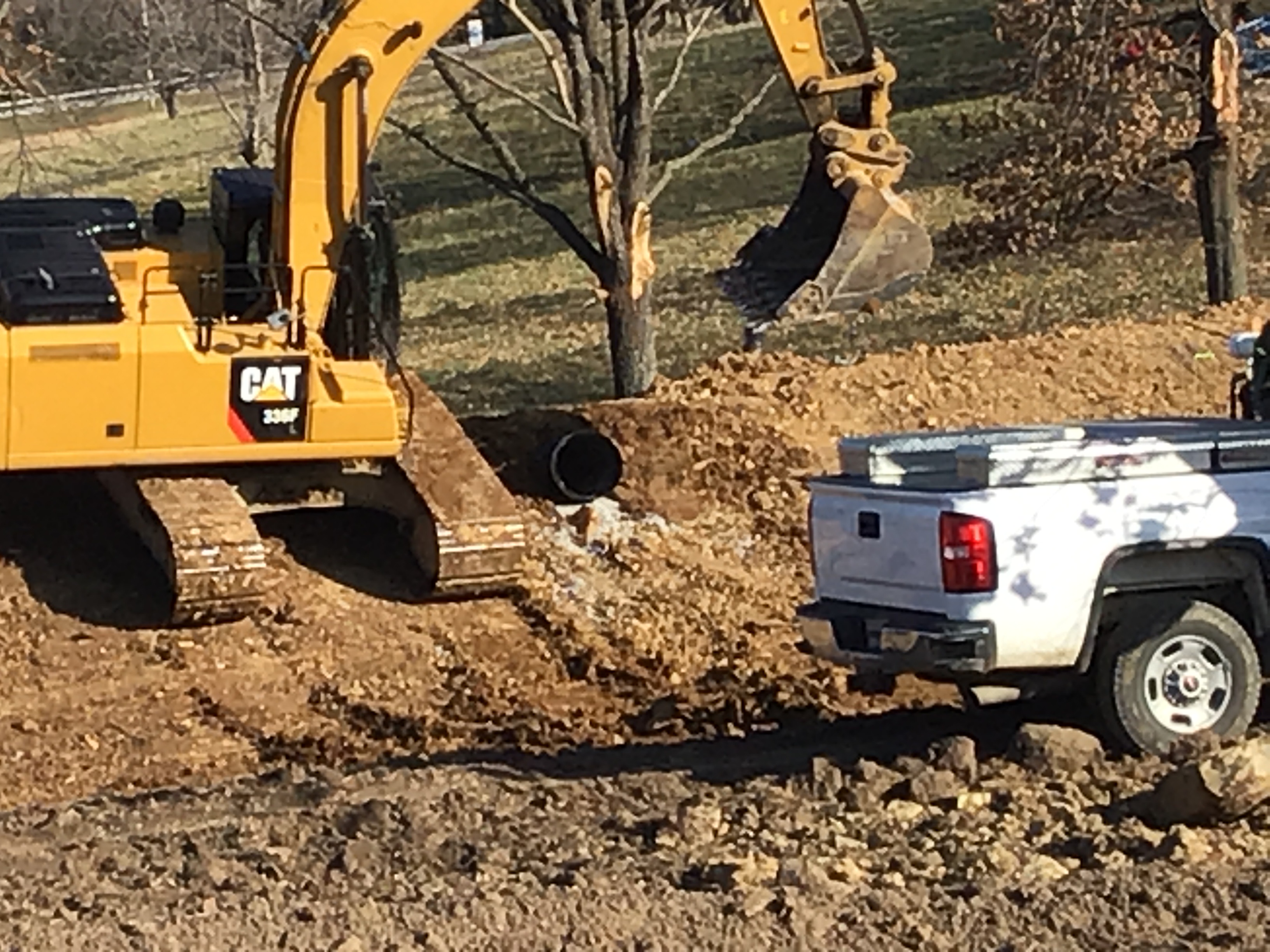

9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/15/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/15/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/15/2020

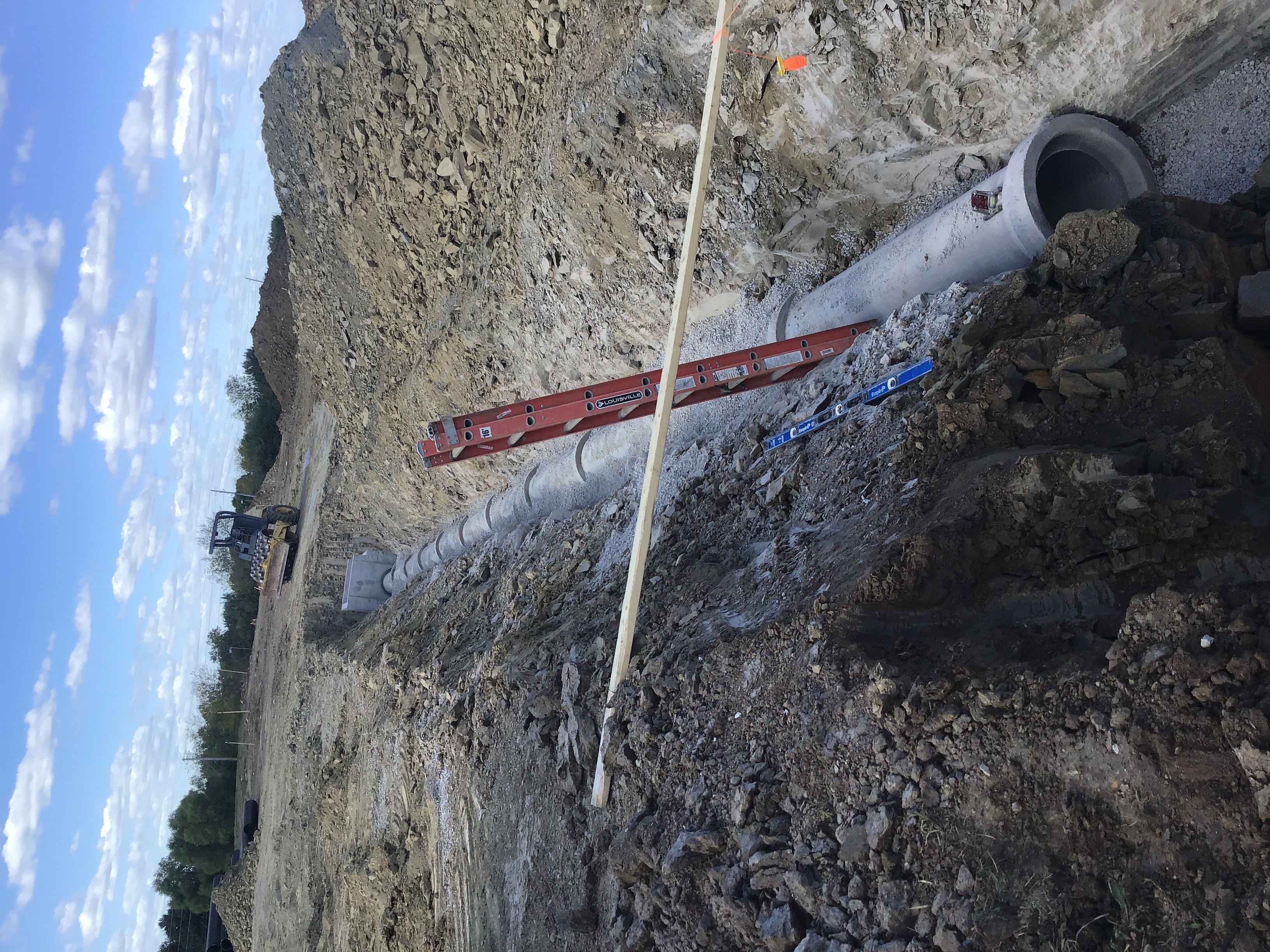

9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/15/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/15/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Sanitary Sewer Construction Inspection Partial 09/16/2020
Misc
Informational
09/15/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/15/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/15/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/15/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/15/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/15/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/15/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/16/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Sanitary Sewer Construction Inspection Partial 09/17/2020
Misc
Informational
09/16/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/16/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/16/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/16/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/16/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/16/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/16/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/16/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/17/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill. Talk with contractor (Ben Forman of Beemer) about the ditch checks required on the lateral lines. After the install of sanitary sewer line he will pour ditch checks.
Sanitary Sewer Construction Inspection Partial 09/18/2020
Misc
Informational
09/17/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/17/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/17/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/17/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/17/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/17/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/17/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/17/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/17/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/18/2020

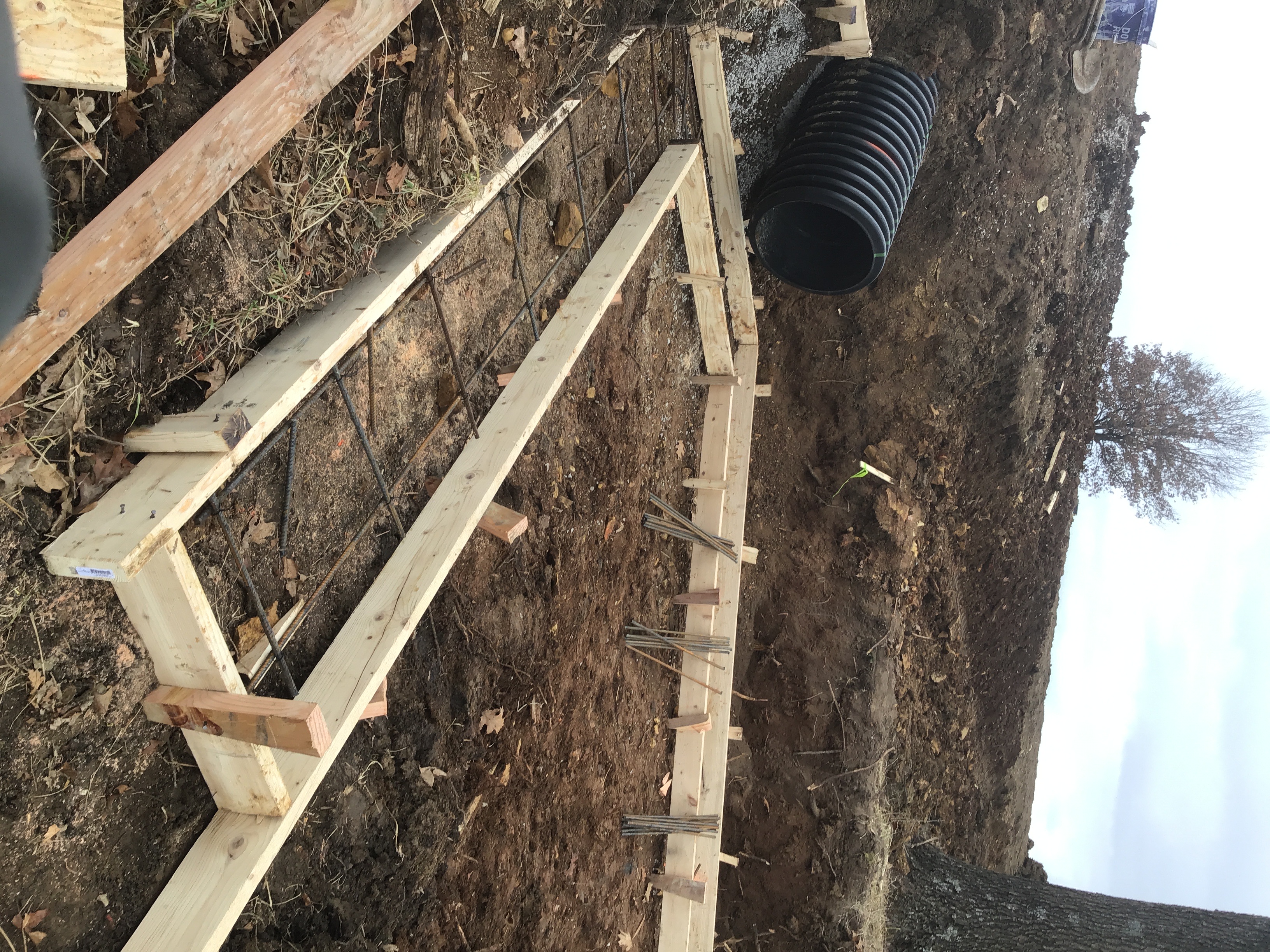

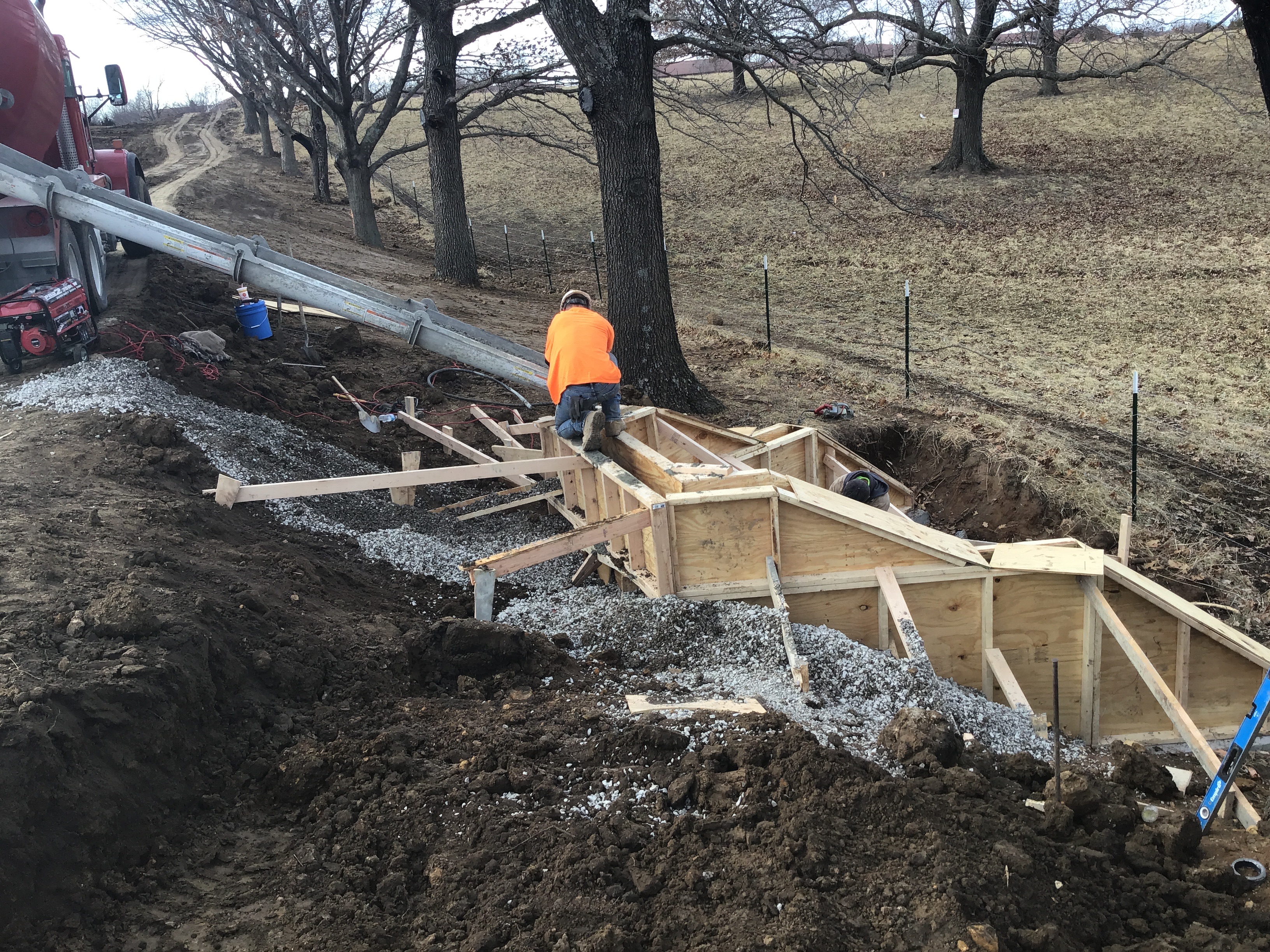

9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Sanitary Sewer Construction Inspection Partial 09/21/2020
Misc
Informational
09/18/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/18/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/18/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/18/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/18/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/18/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/18/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/18/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/18/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/18/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/21/2020

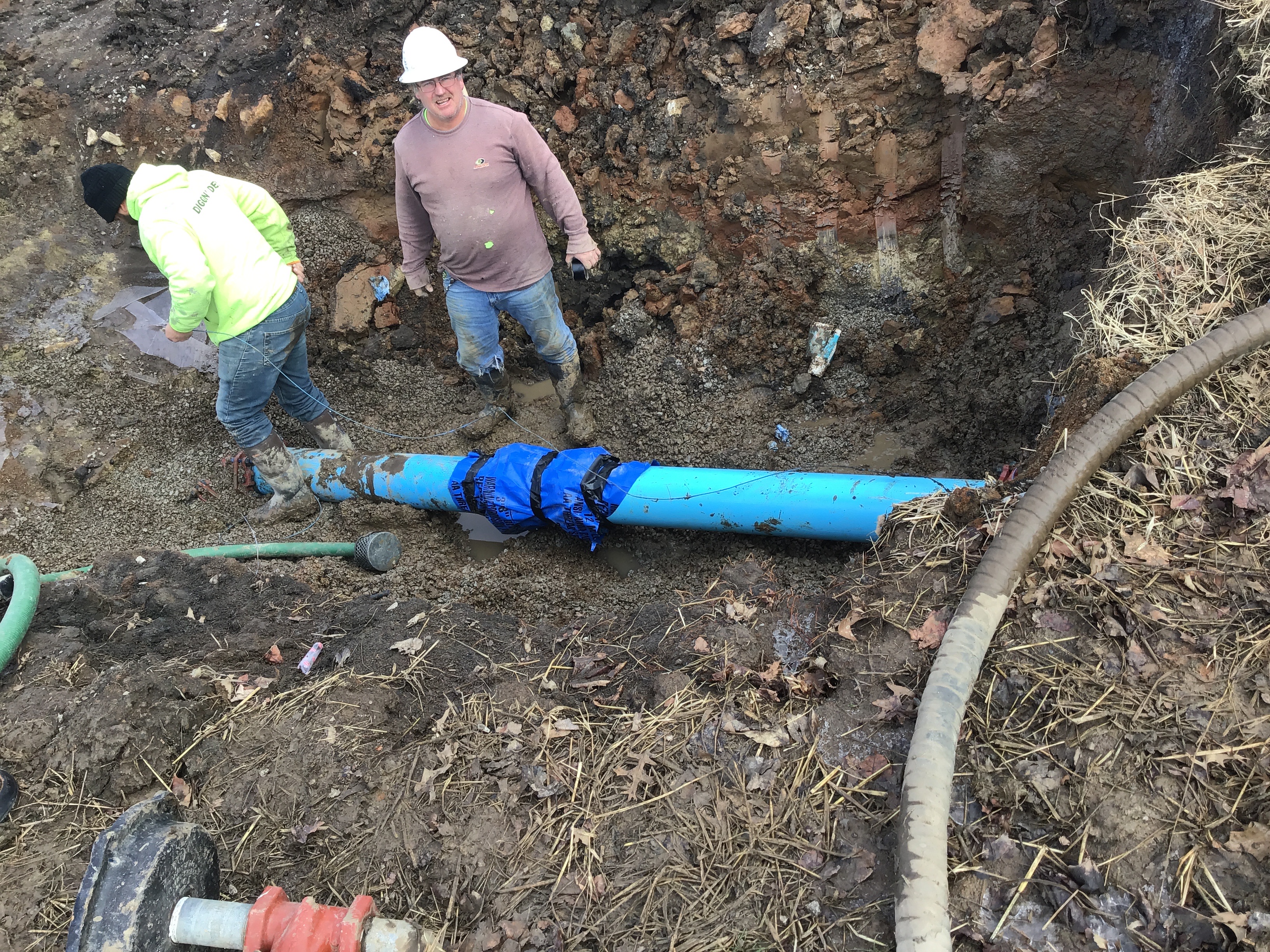

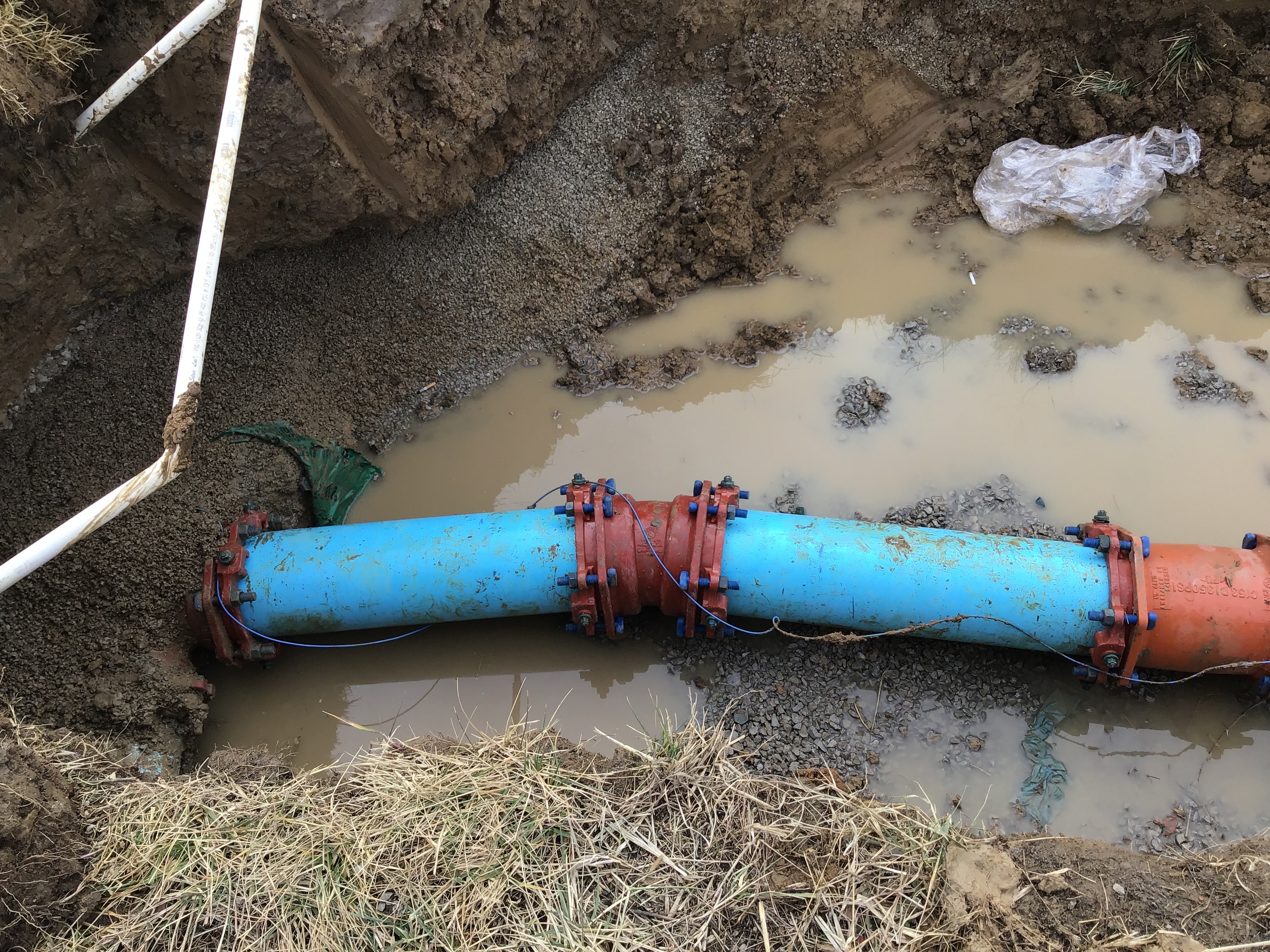

9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Sanitary Sewer Construction Inspection Partial 09/22/2020
Misc
Informational
09/21/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/21/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/21/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/21/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/21/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/21/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/21/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/21/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/21/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/21/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/21/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/22/2020

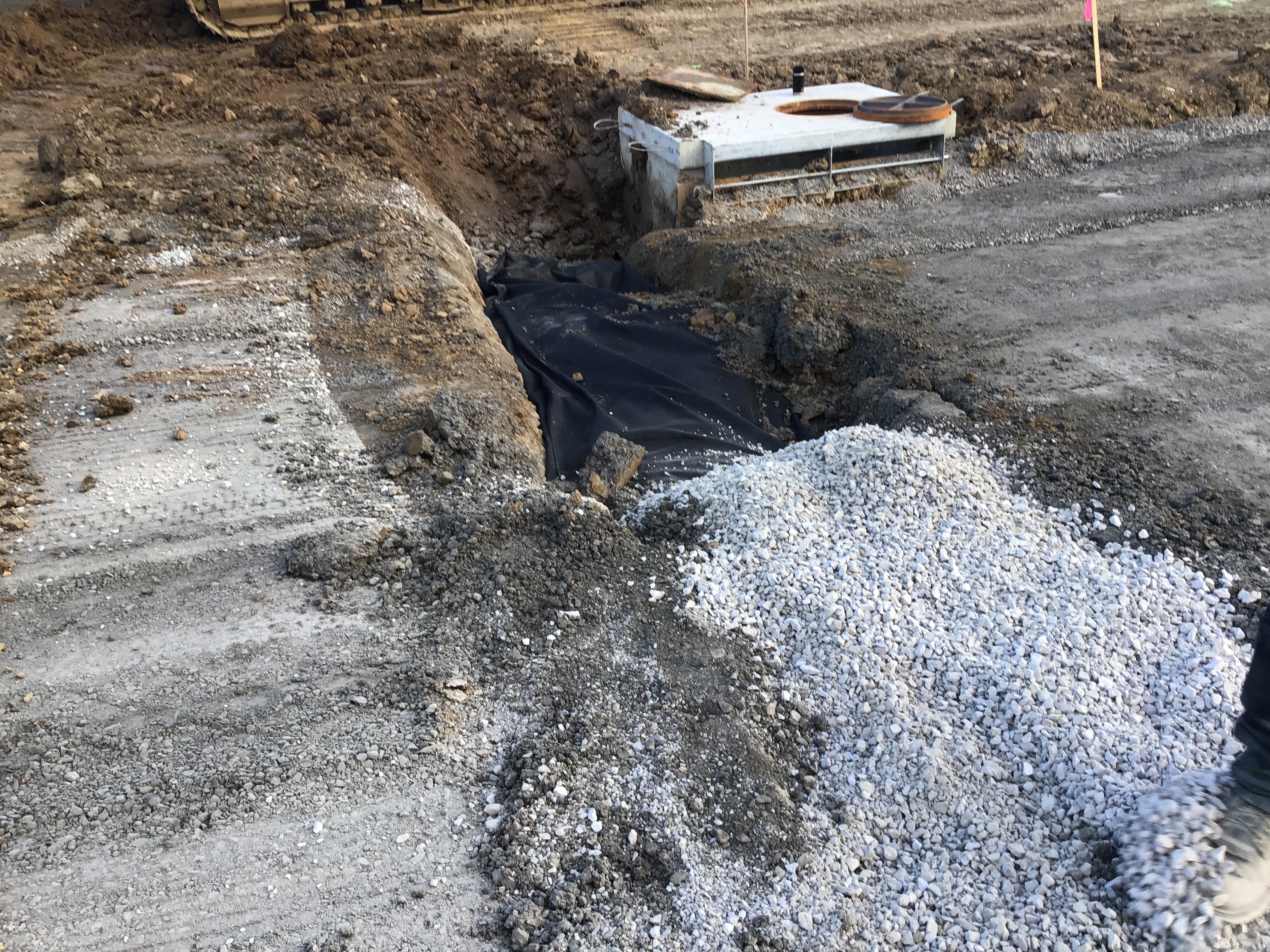

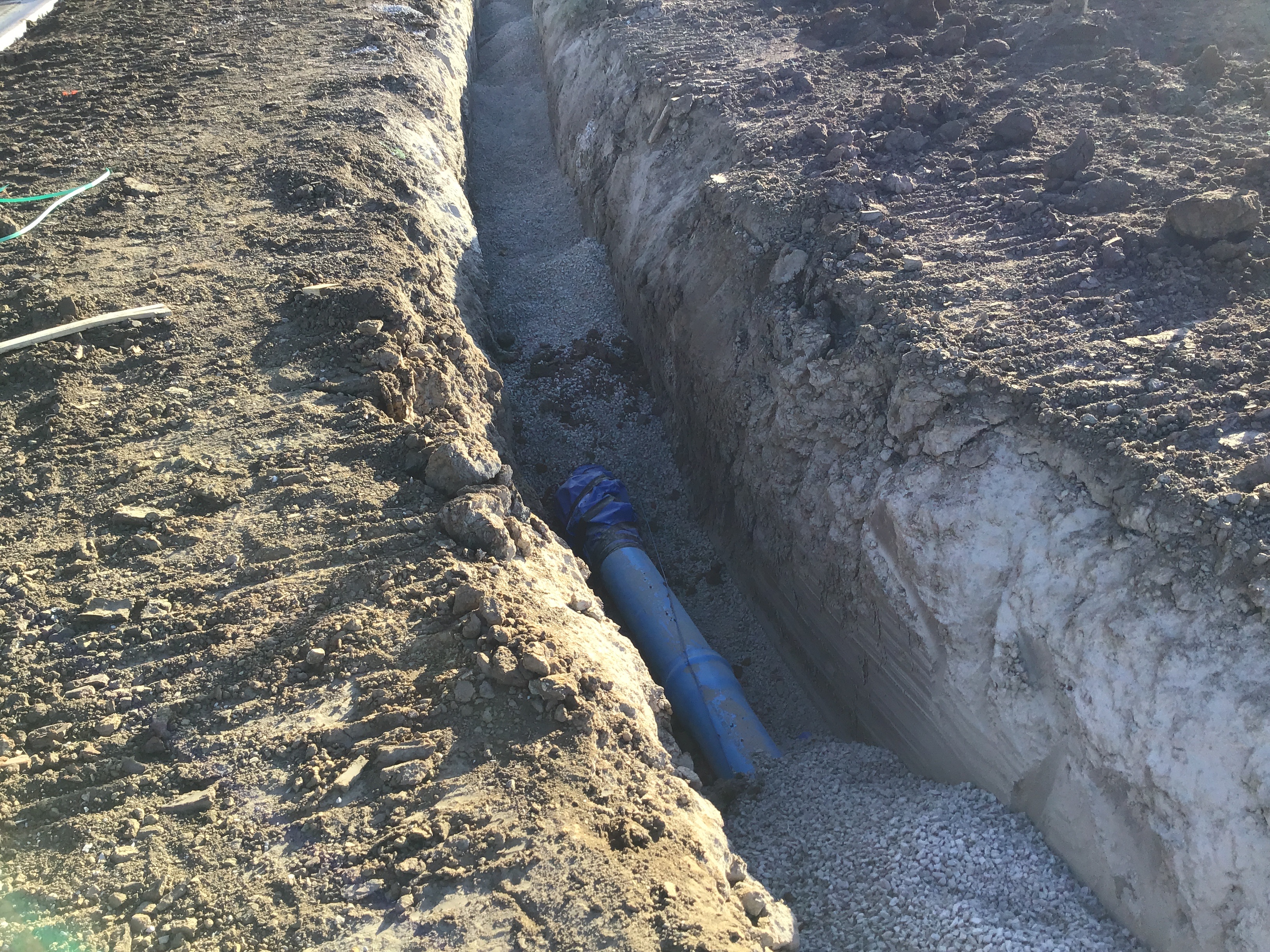

9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Sanitary Sewer Construction Inspection Partial 09/23/2020
Misc
Informational
09/22/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/22/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/22/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/22/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/22/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/22/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/22/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/22/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/22/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/22/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/22/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/22/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/23/2020

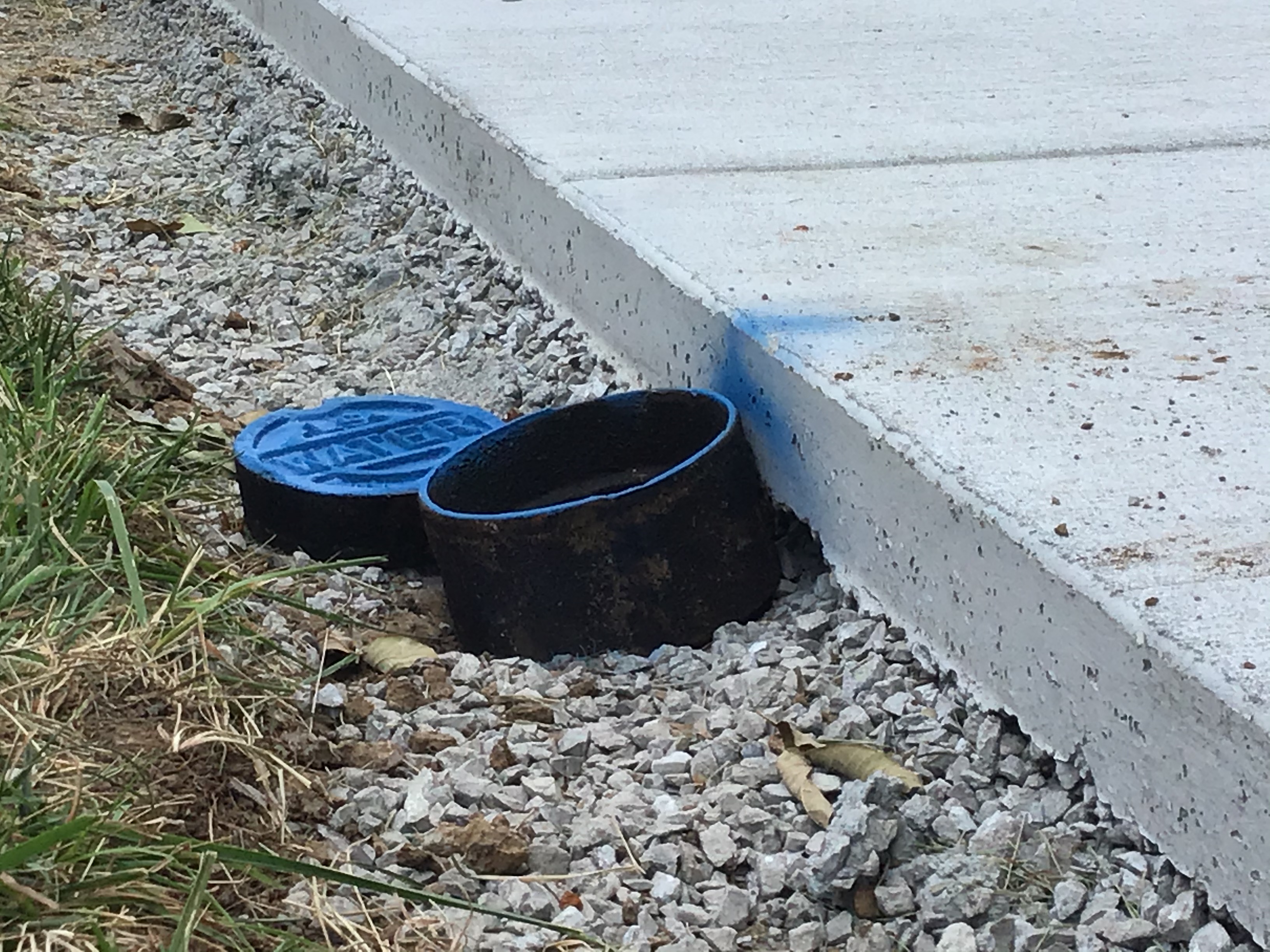

9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Sanitary Sewer Construction Inspection Partial 09/24/2020
Misc
Informational
09/23/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/23/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/23/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/23/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/23/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/23/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/23/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/23/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/23/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/23/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/23/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/23/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/23/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
09/24/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Sanitary Sewer Construction Inspection Partial 09/25/2020
Misc
Informational
09/24/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/24/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/24/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/24/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/24/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/24/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/24/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/24/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/24/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/24/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/24/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/24/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/24/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
09/24/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
09/25/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2. Contractor poured trench checks to newly installed laterals and backfilled excavation for the weekend.
Sanitary Sewer Construction Inspection Partial 09/28/2020
Misc
Informational
09/25/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/25/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/25/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/25/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/25/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/25/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/25/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/25/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/25/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/25/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/25/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/25/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/25/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
09/25/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
09/25/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
09/28/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Sanitary Sewer Construction Inspection Partial 09/29/2020
Misc
Informational
09/28/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/28/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/28/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/28/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/28/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/28/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/28/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/28/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/28/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/28/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/28/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/28/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/28/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
09/28/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
09/28/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
09/28/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Misc
Informational
09/29/2020
9/29/20 Tuesday Contractor installed Laterals for Lot 109, 110, & 153 and the top half of the MH 2-3. Ditch checks were pour on laterals. Inverts for MHs on project will be poured and formed upcoming.
Storm Sewer Construction Inspection Partial 10/01/2020
Misc
Informational
09/30/2020

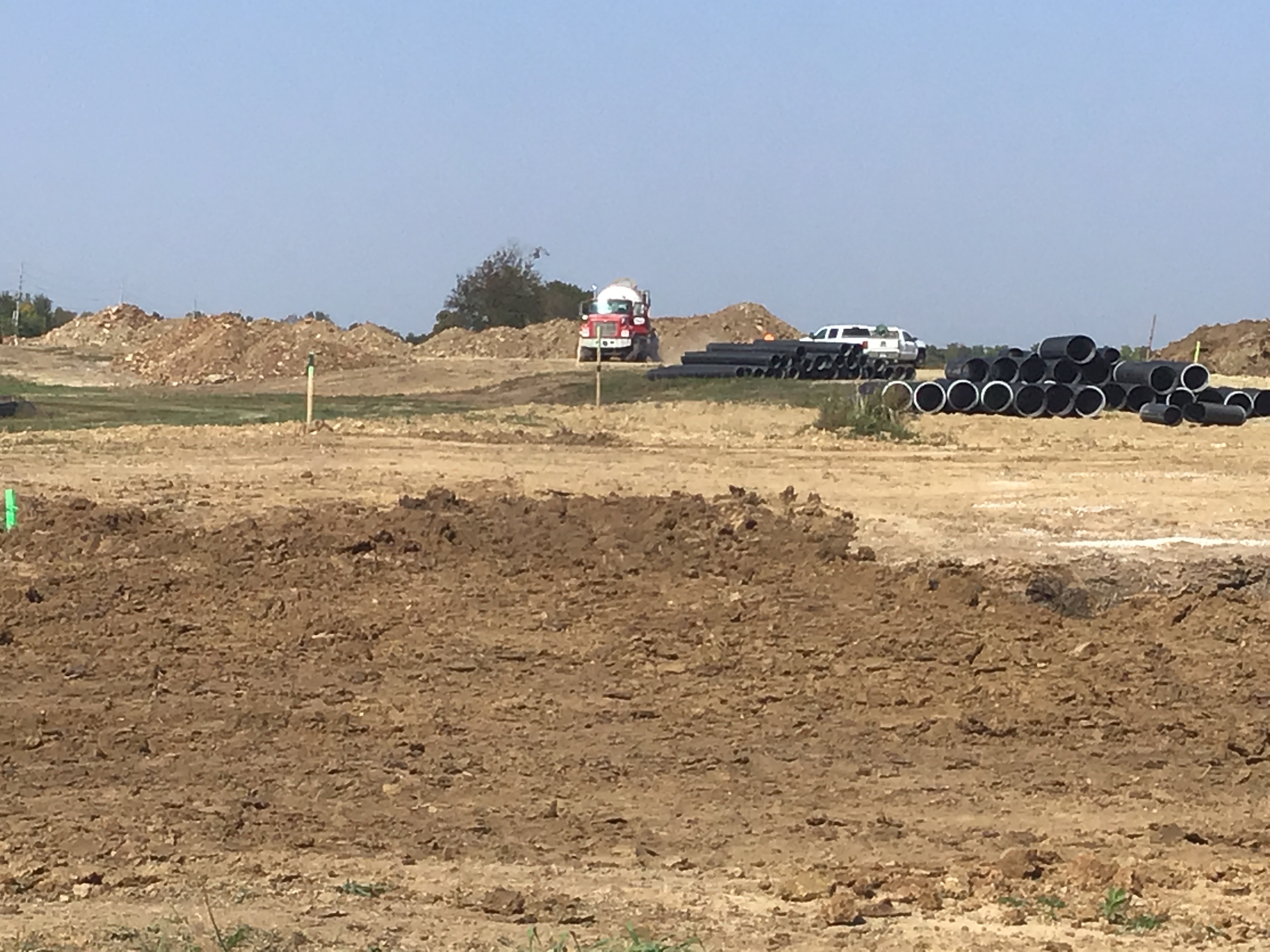

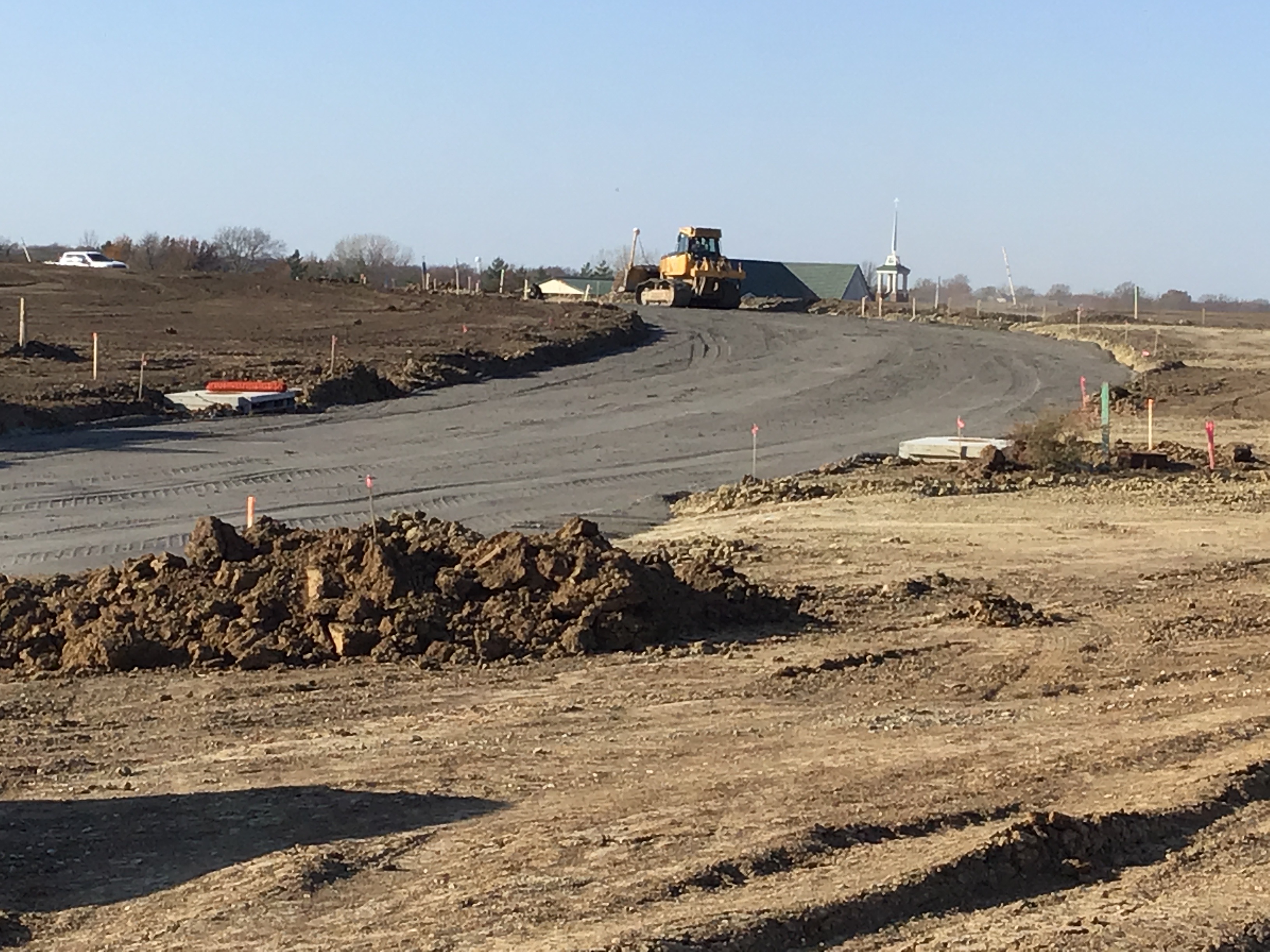

Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/01/2020

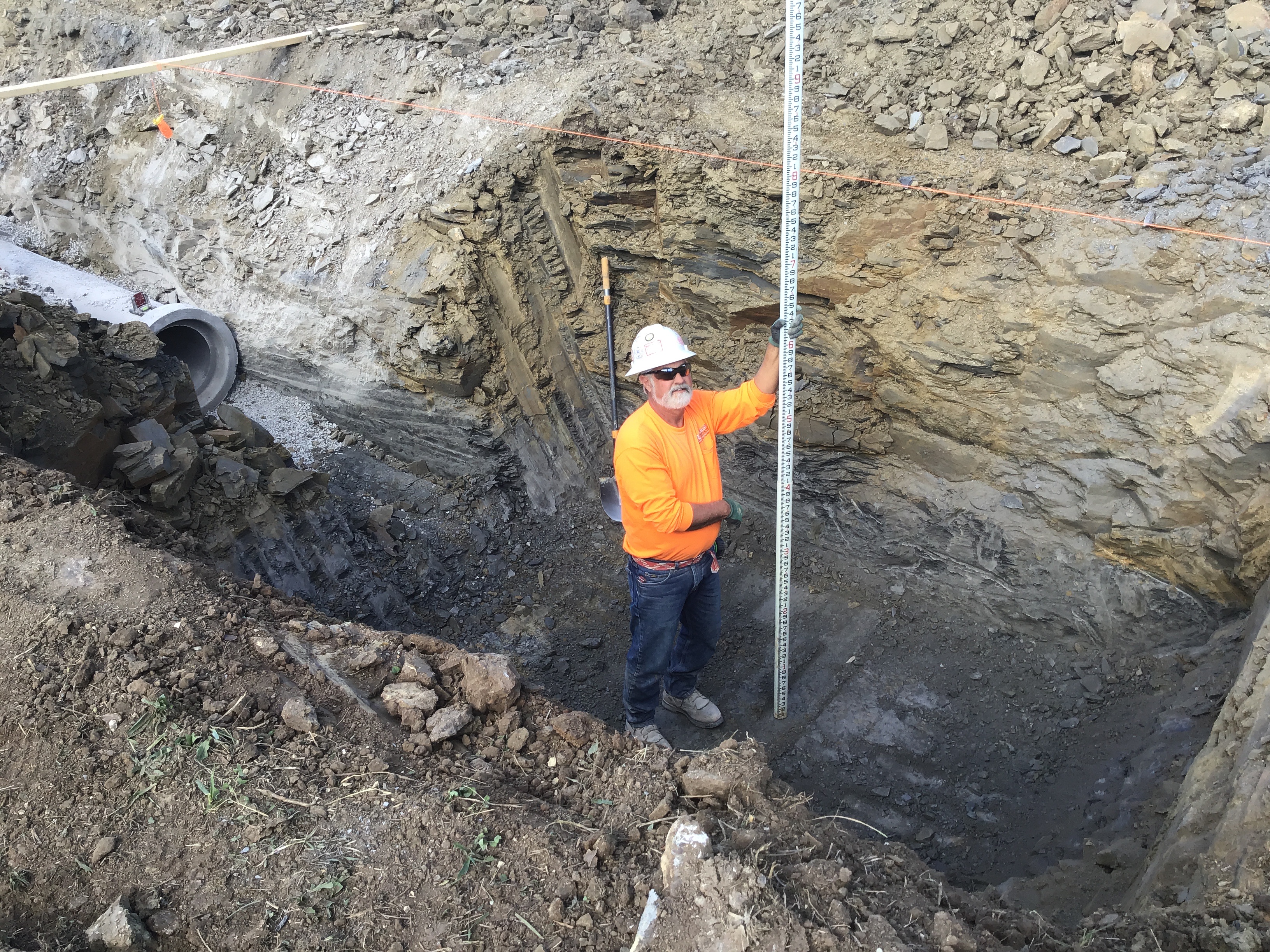

10/1/20 Thursday Contractor began storm sewer install on Storm 2 at 5’x 4’ Curb Inlet 2-2, and 80’ of 24” HDPE pipe.
Storm Sewer Construction Inspection Partial 10/01/2020
Misc
Informational
10/01/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/01/2020

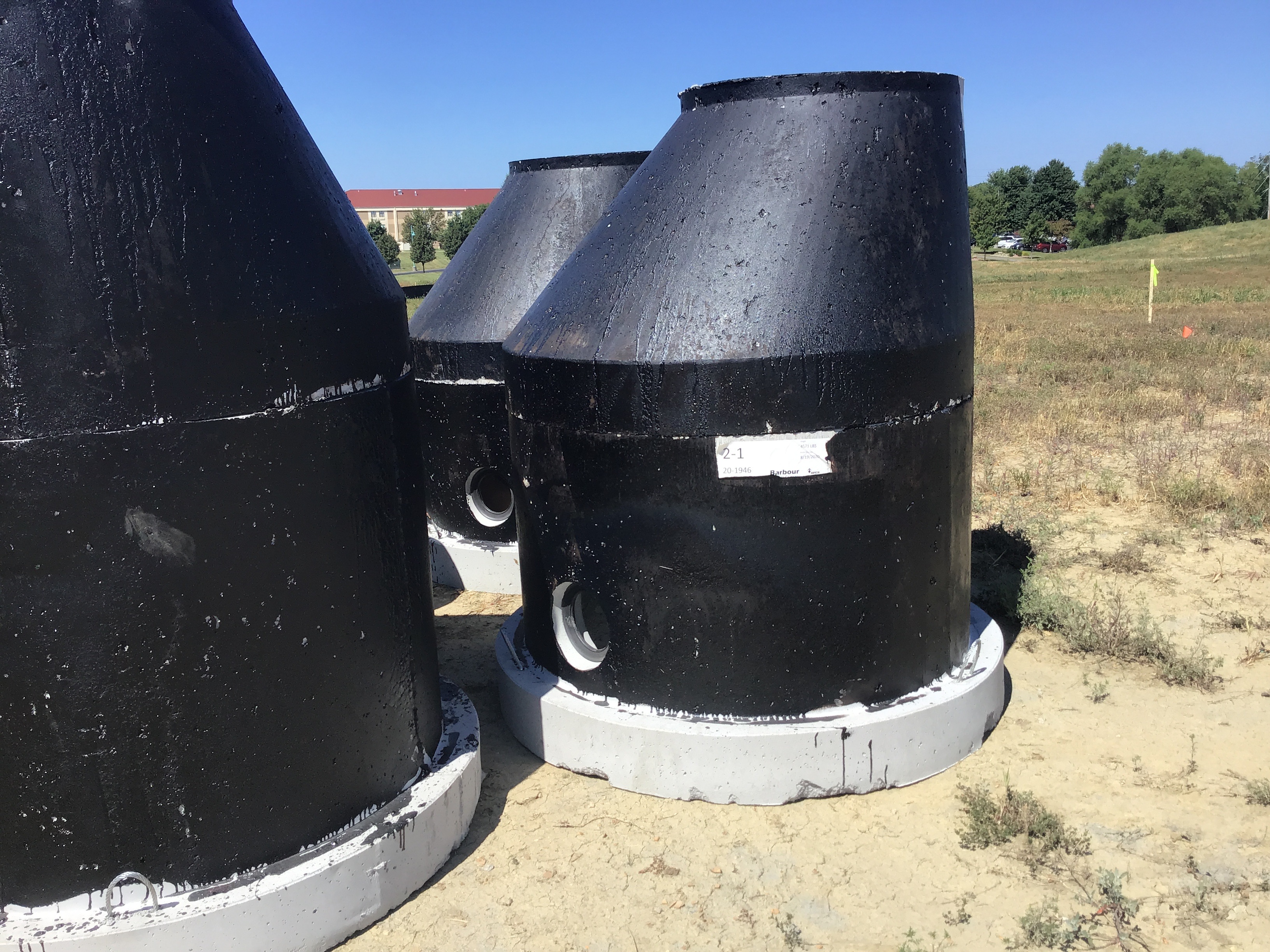

10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Storm Sewer Construction Inspection Partial 10/02/2020
Misc
Informational
10/01/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/01/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/02/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Storm Sewer Construction Inspection Partial 10/05/2020
Misc
Informational
10/02/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/02/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/02/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/05/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Water Line - Construction Inspection Partial 10/05/2020
Misc
Informational

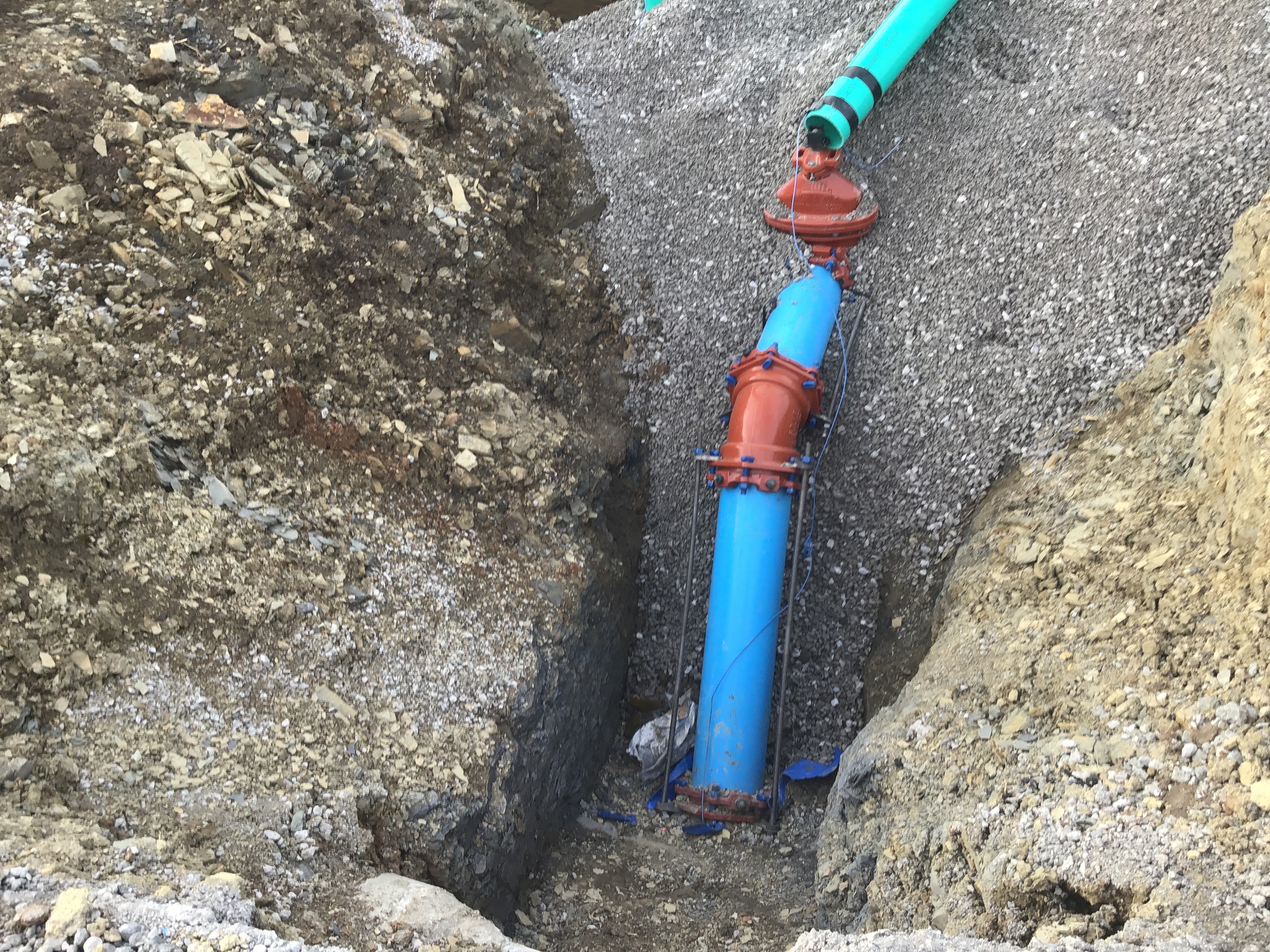

10/05/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy
Storm Sewer Construction Inspection Partial 10/06/2020
Misc
Informational
10/05/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/05/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/05/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/05/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/06/2020

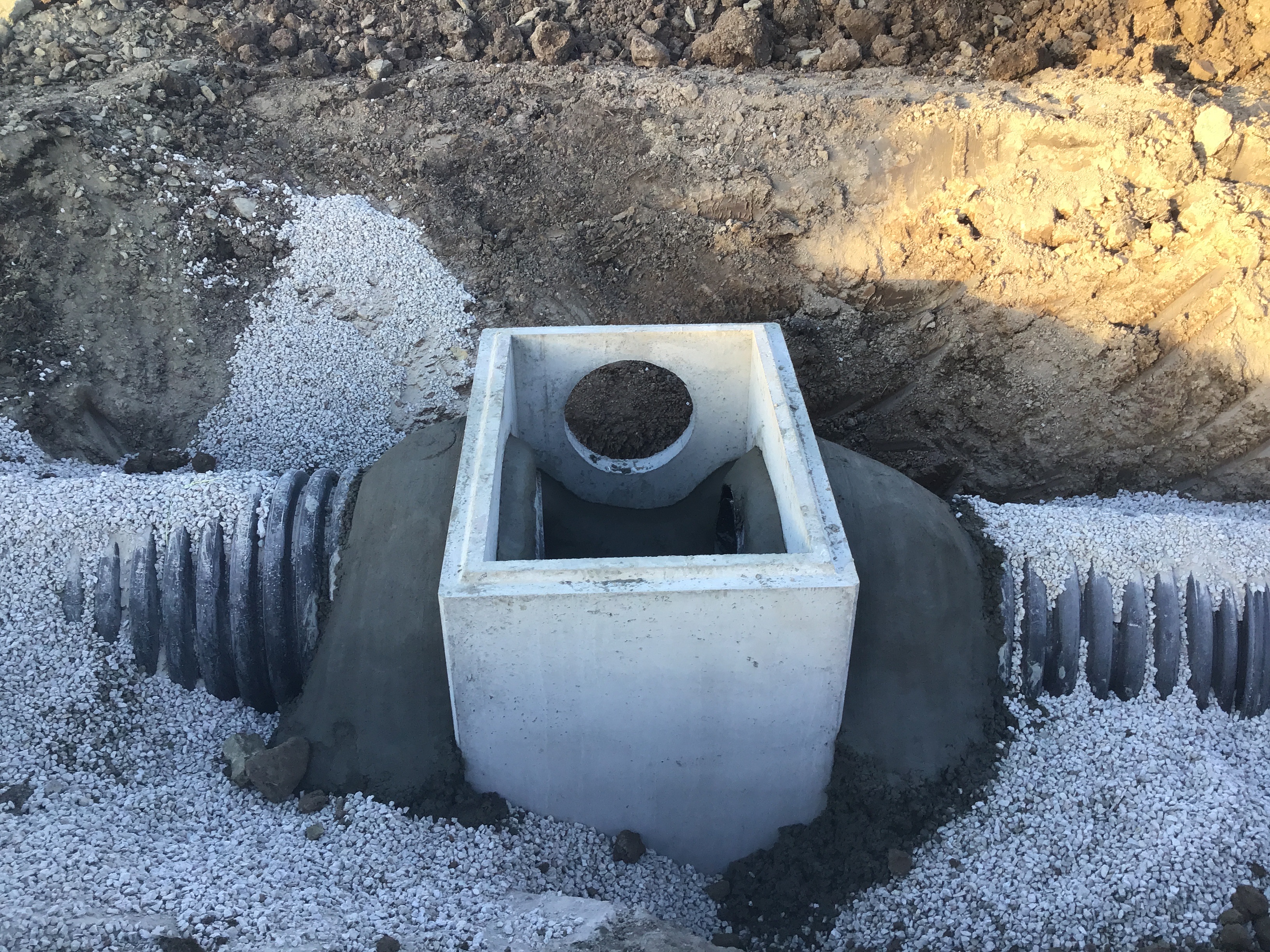

10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Storm Sewer Construction Inspection Partial 10/07/2020
Misc
Informational
10/06/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/06/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/06/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/06/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/06/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/07/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Storm Sewer Construction Inspection Partial 10/08/2020
Misc
Informational
10/07/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/07/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/07/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/07/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/07/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/07/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/08/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Storm Sewer Construction Inspection Partial 10/09/2020
Misc
Informational
10/08/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/08/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/08/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/08/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/08/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/08/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/08/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/09/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7. Inverts and collars were poured on curb inlets.
Storm Sewer Construction Inspection Partial 10/12/2020
Misc
Informational
10/09/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/09/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/09/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/09/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/09/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/09/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/09/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/09/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Storm Sewer Construction Inspection Partial 10/13/2020
Misc
Informational
10/12/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/12/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/12/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/12/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/12/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/12/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/12/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/12/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/12/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/13/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Storm Sewer Construction Inspection Partial 10/14/2020
Misc
Informational
10/13/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/13/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/13/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/13/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/13/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/13/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/13/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/13/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/13/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/13/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/14/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Storm Sewer Construction Inspection Partial 10/15/2020
Misc
Informational
10/14/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/14/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/14/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/14/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/14/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/14/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/14/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/14/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/14/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/14/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/14/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/15/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Water Line - Construction Inspection Partial 10/16/2020
Misc
Informational
10/16/2020
10/16/20 Friday Contractor installed 8” C-900 water main on Line 2 @ the South end of project.
Storm Sewer Construction Inspection Partial 10/16/2020
Misc
Informational
10/15/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/15/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/15/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/15/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/15/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/15/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/15/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/15/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/15/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/15/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/15/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/15/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Water Line - Construction Inspection Partial 10/19/2020
Misc
Informational
10/16/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
10/19/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Storm Sewer Construction Inspection Partial 10/19/2020
Misc
Informational
10/16/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/16/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/16/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/16/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/16/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/16/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/16/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/16/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/16/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/16/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/16/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/16/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/16/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Storm Sewer Construction Inspection Partial 10/21/2020
Misc
Informational
10/19/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/19/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/19/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/19/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/19/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/19/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/19/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/19/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/19/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/19/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/19/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/19/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/19/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/19/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/21/2020

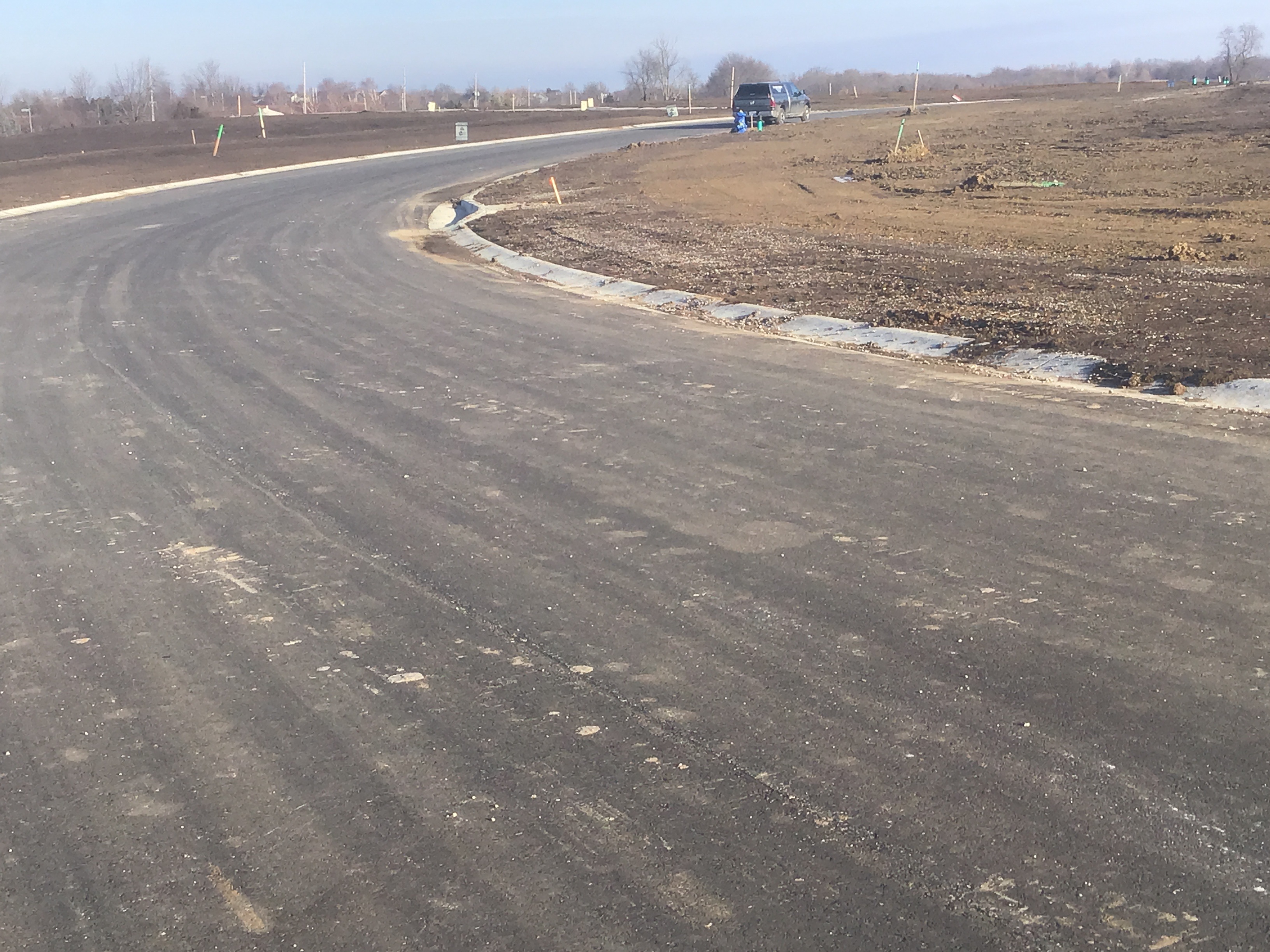

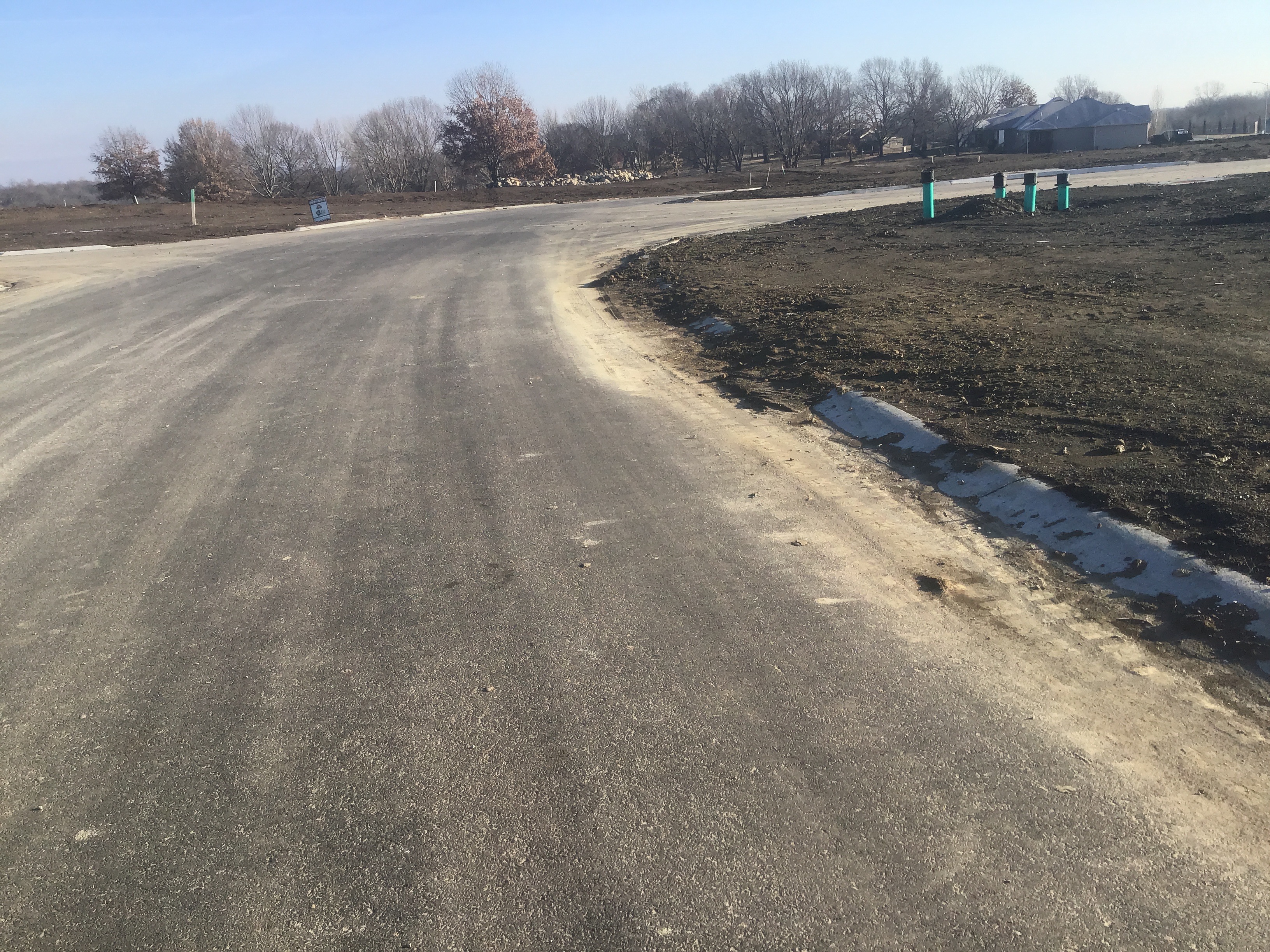

10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4.
Grading/Excavation/Fill Inspection Partial 10/21/2020
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor (Spaulding) grading site and started late last week.
Storm Sewer Construction Inspection Partial 10/21/2020
Misc
Informational
10/21/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/21/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/21/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/21/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/21/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/21/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/21/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/21/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/21/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/21/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/21/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/21/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/21/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/21/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Storm Sewer Construction Inspection Partial 10/22/2020
Misc
Informational
10/21/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/21/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/21/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/21/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/21/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/21/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/21/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/21/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/21/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/21/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/21/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/21/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/21/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/21/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continued work on Storm Line 5.
Grading/Excavation/Fill Inspection Partial 10/22/2020
Misc
Informational
10/21/2020
10/21/20 Wednesday Contractor (Spaulding) grading site and started late last week.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continue to Grade and Excavate site.
Storm Sewer Construction Inspection Partial 10/22/2020
Misc
Informational
10/22/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/22/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/22/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/22/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/22/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/22/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/22/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/22/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/22/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/22/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/22/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/22/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/22/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/22/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/22/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Erosion Control Inspection Partial 10/23/2020
Misc
Informational
10/23/2020
Contractor has maintained construction entrance we will continue to monitor site to ensure sediment doesn’t leave the site.
Sanitary Sewer Construction Inspection Partial 10/27/2020
Misc
Informational
09/29/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
09/29/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
09/29/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
09/29/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
09/29/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
09/29/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
09/29/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
09/29/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
09/29/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
09/29/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
09/29/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
09/29/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
09/29/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
09/29/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
09/29/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
09/29/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Misc
Informational
09/29/2020
9/29/20 Tuesday Contractor installed Laterals for Lot 109, 110, & 153 and the top half of the MH 2-3.
Misc
Informational

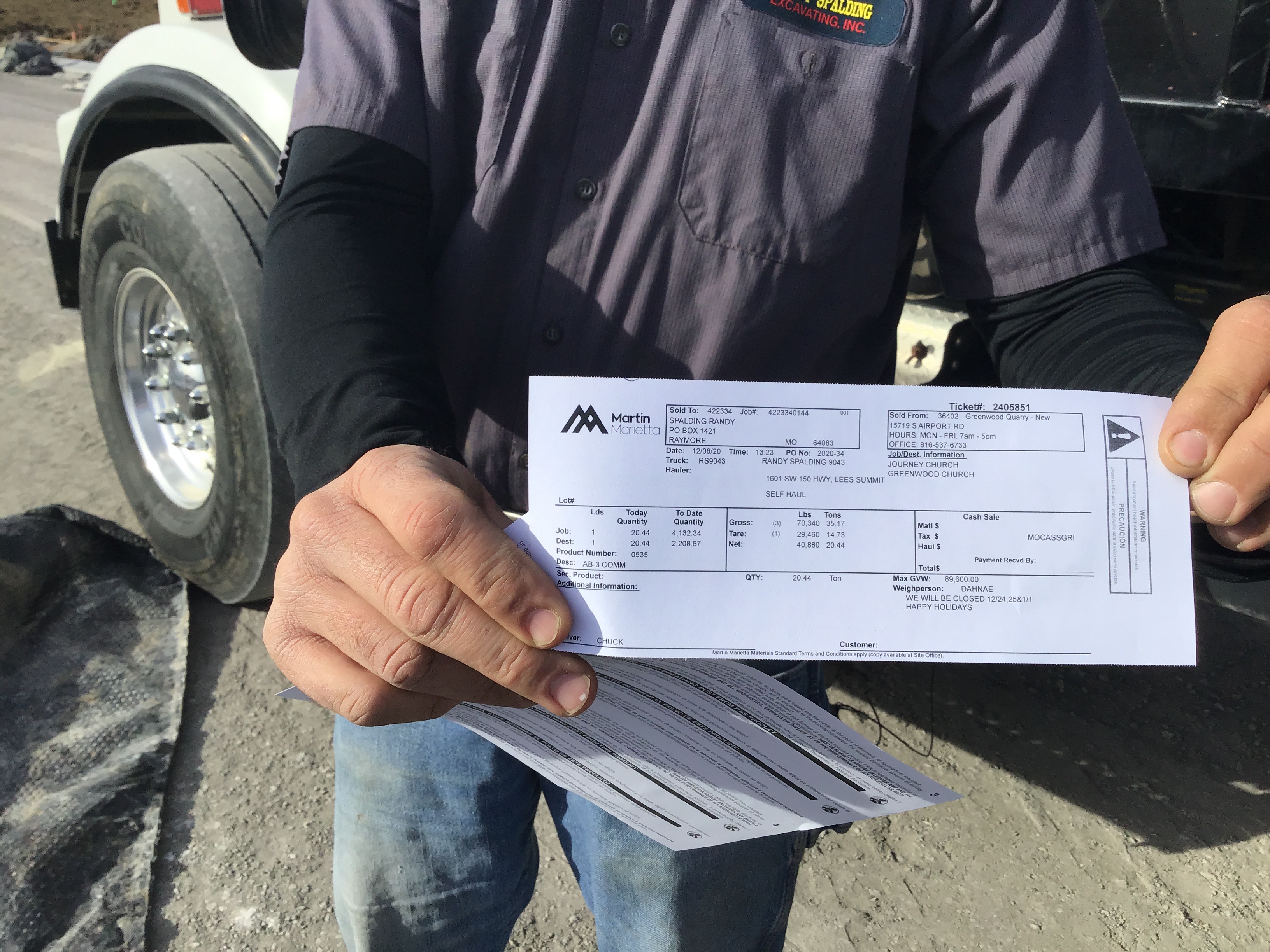

10/27/2020
10/27/20 Tuesday Contractor installed Laterals for Lot 122 & 127 and backfilled excavation. Contractor stopped the due to inclement weather.
Sanitary Sewer Construction Inspection Partial 10/28/2020
Misc
Informational
10/27/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
10/27/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
10/27/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
10/27/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
10/27/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
10/27/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
10/27/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
10/27/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
10/27/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
10/27/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
10/27/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
10/27/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
10/27/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
10/27/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
10/27/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
10/27/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Misc
Informational
10/27/2020
9/29/20 Tuesday Contractor installed Laterals for Lot 109, 110, & 153 and the top half of the MH 2-3.
Misc
Informational
10/27/2020
10/27/20 Tuesday Contractor installed Laterals for Lot 122 & 127 and backfilled excavation. Contractor stopped the due to inclement weather.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor installed the service Line for Lot 121 from Sanitary Line G is in the easement that runs right by the Lot 121. Contractor will reflect change on as-built. I talk with the engineer before approval was given this will be listed as a field change. 2 Max Adaptor were in on both side of the wye that was installed on existing sanitary Line G.
Storm Sewer Construction Inspection Partial 10/28/2020
Misc
Informational
10/22/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/22/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/22/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/22/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/22/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/22/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/22/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/22/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/22/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/22/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/22/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/22/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/22/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/22/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/22/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Storm Sewer Construction Inspection Partial 11/02/2020
Misc
Informational
10/28/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
10/28/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
10/28/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
10/28/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
10/28/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
10/28/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
10/28/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
10/28/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
10/28/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
10/28/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
10/28/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
10/28/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
10/28/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
10/28/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
10/28/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
10/28/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/02/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Storm Sewer Construction Inspection Partial 11/11/2020
Misc
Informational
11/02/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
11/02/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
11/02/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
11/02/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
11/02/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
11/02/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
11/02/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
11/02/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
11/02/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
11/02/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
11/02/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
11/02/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
11/02/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
11/02/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
11/02/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
11/02/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
11/02/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/02/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Sanitary Sewer Construction Inspection Partial 11/13/2020
Misc
Informational
10/28/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
10/28/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
10/28/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
10/28/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
10/28/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
10/28/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
10/28/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
10/28/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
10/28/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
10/28/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
10/28/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
10/28/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
10/28/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
10/28/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
10/28/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
10/28/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Misc
Informational
10/28/2020
9/29/20 Tuesday Contractor installed Laterals for Lot 109, 110, & 153 and the top half of the MH 2-3.
Misc
Informational
10/28/2020
10/27/20 Tuesday Contractor installed Laterals for Lot 122 & 127 and backfilled excavation. Contractor stopped the due to inclement weather.
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor installed the service Line for Lot 121 from Sanitary Line G is in the easement that runs right by the Lot 121. Contractor will reflect change on as-built. I talk with the engineer before approval was given this will be listed as a field change. 2 Max Adaptor were in on both side of the wye that was installed on existing sanitary Line G.
Misc
Informational
11/11/2020
11/11/20 Wednesday Contractor is pre-test sanitary line for pressure test.
Misc
Informational
11/13/2020
11/13/20 Friday Contractor continued to pre-test and fine any leaks on newly installed Certa - Lock tees.
Grading/Excavation/Fill Inspection Partial 11/13/2020
Misc
Informational
10/22/2020
10/21/20 Wednesday Contractor (Spaulding) grading site and started late last week.
Misc
Informational
10/22/2020
10/22/20 Thursday Contractor continue to Grade and Excavate site.
Misc
Informational
11/13/2020
11/13/20 Friday Contractor continued to Grade and Excavate site for detention basins and street.
Sanitary Sewer - Air Test Passed 11/17/2020
Misc
Informational
11/17/2020
11/17/20 Tuesday Air Test passed on newly installed lines on sanitary 1 & 2 and the existing sanitary with the newly installed MAXADAPTOR COUPLINGS for the sanitary wyes.
Sanitary Sewer - Vacuum Passed 11/17/2020
Misc
Informational
11/17/2020
11/17/20 Tuesday Vacuum test were done and passed on Manholes on sanitary lines 1 & 2 (as-per project plans).
Sanitary Sewer - Mandrel Passed 11/17/2020
Misc
Informational
11/17/2020
11/17/20 Tuesday Contractor (Holthouse)Pulled Mandrel through sanitary lines 1& 2 and passed .
Pavement-Stabilized Subgrade Passed 11/18/2020
Misc
Informational
11/18/2020
11/18/20 Thursday Stabilization of the subgrade for the new street construction passed. One soft area where water collected at the begin of the project NE Jamestown Dr. & NE Goshen Dr. .
Curb - Proof Roll Passed 11/18/2020
Misc
Informational
11/18/2020

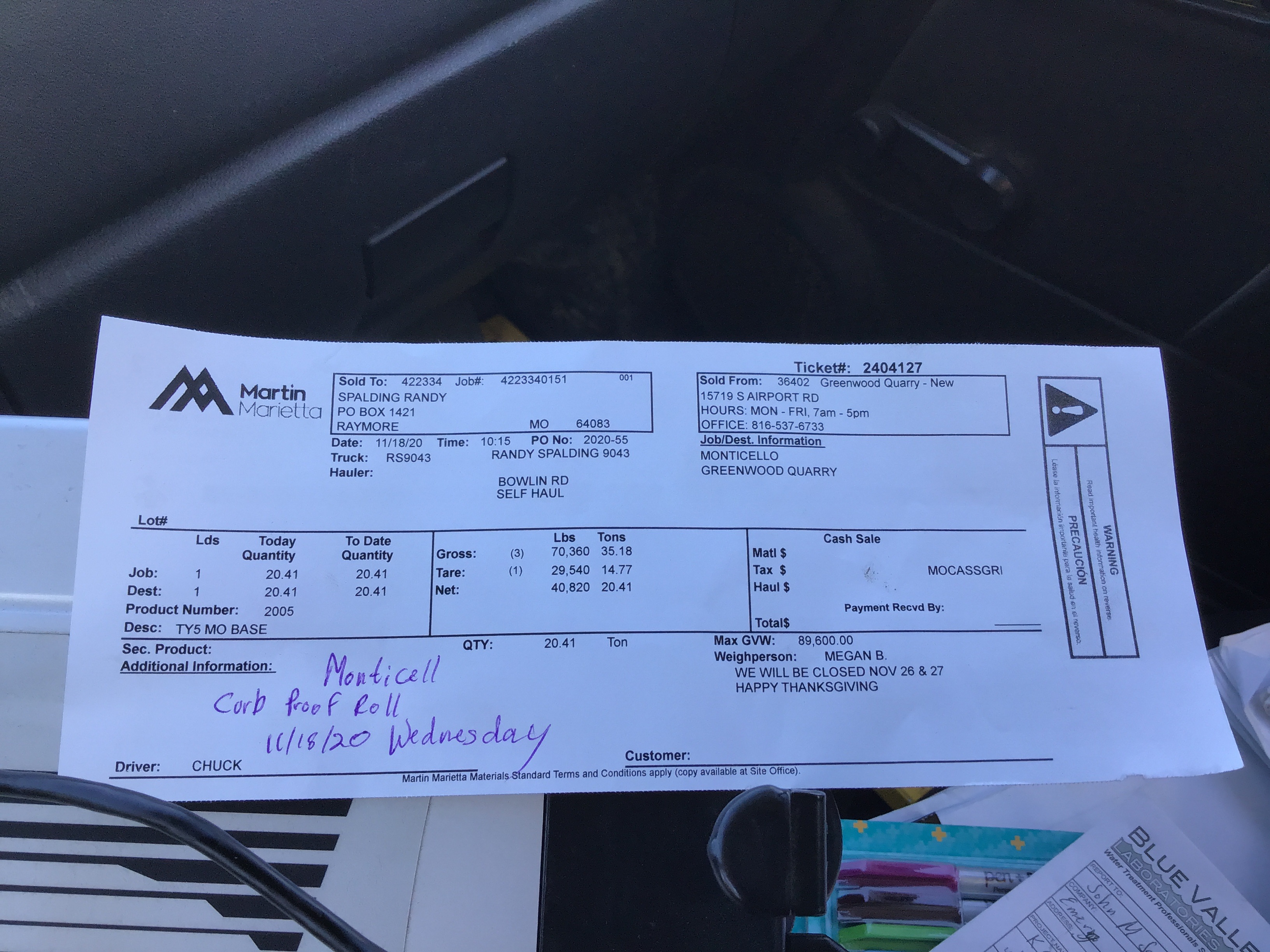

11/18/20 Wednesday Curb proof passed to day for the subgrade of streets on project.
Storm Sewer Construction Inspection Partial 11/18/2020
Misc
Informational
11/11/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
11/11/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
11/11/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
11/11/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
11/11/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
11/11/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
11/11/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
11/11/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
11/11/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
11/11/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
11/11/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
11/11/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
11/11/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
11/11/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
11/11/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
11/11/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
11/11/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/11/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Pavement-Aggregate Base Partial 11/18/2020
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
12/09/2020

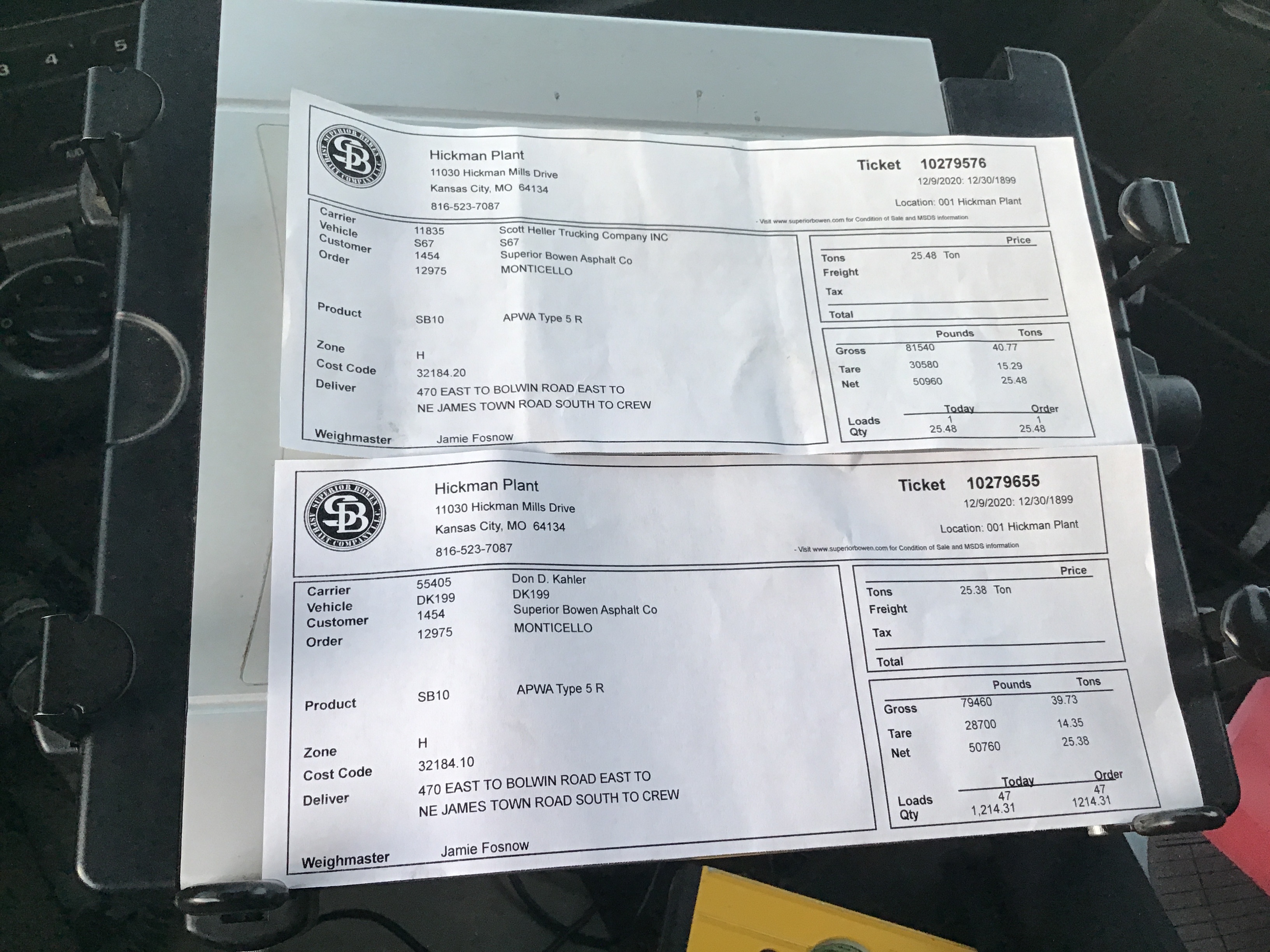

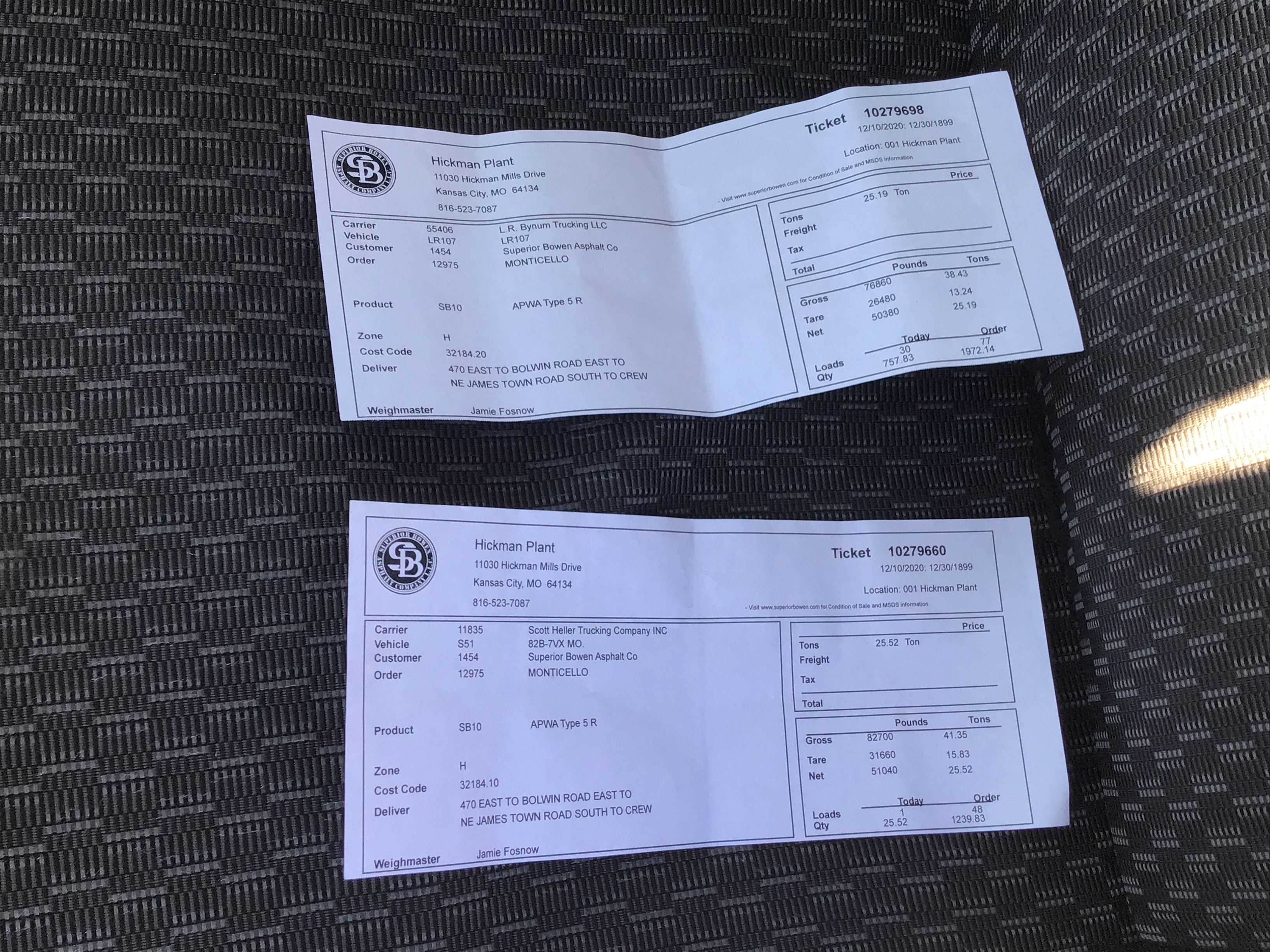

12/8/20 Wednesday Contractor ( Superior Boeing ) starting installation of aggregate base around 11:50AM.
Storm Sewer Construction Inspection Partial 11/19/2020
Misc
Informational
11/18/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
11/18/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
11/18/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
11/18/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
11/18/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
11/18/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
11/18/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
11/18/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
11/18/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
11/18/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
11/18/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
11/18/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
11/18/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
11/18/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
11/18/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
11/18/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
11/18/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/18/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
11/19/2020
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Pavement-Aggregate Base Partial 11/19/2020
Misc
Informational
11/18/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
11/19/2020
11/19/20 Thursday Contractor (Spaulding) continues laying base rock on streets over treated sub grade.
Storm Sewer Construction Inspection Partial 11/20/2020
Misc
Informational
11/19/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
11/19/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
11/19/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
11/19/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
11/19/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
11/19/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
11/19/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
11/19/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
11/19/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
11/19/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
11/19/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
11/19/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
11/19/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
11/19/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
11/19/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
11/19/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
11/19/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/19/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
11/19/2020
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
11/19/2020
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Pavement-Aggregate Base Partial 11/20/2020
Misc
Informational
11/19/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
11/19/2020
11/19/20 Thursday Contractor (Spaulding) continues laying base rock on streets over treated sub grade.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor (Spaulding Const.) continued preparing streets that were base rocked.
Curb - Proof Roll Passed 11/30/2020
Misc
Informational
11/30/2020
Proof roll passed inspection.
Public Curb Inspection Partial 12/04/2020
Misc
Informational
12/04/2020
12/4/20 Friday 8:30 AM Contractor ( Turner & Michael Const. ) started pouring curbs for the subdivision project. Curb installation will run throughout the day. Geiger is the delivering concrete.
Public Curb Inspection Partial 12/05/2020
Misc
Informational
12/04/2020
12/4/20 Friday 8:30 AM Contractor ( Turner & Michael Const. ) started pouring curbs for the subdivision project. Curb installation will run throughout the day. Geiger is the delivering concrete.
Misc
Informational
12/05/2020
12/5/20 Saturday 8:20 AM Contractor covered curbs with blankets ( cold weather specifications) and testing cylinders on 12/4/20 Friday
Public Curb Inspection Partial 12/08/2020
Misc
Informational
12/05/2020
12/4/20 Friday 8:30 AM Contractor ( Turner & Michael Const. ) started pouring curbs for the subdivision project. Curb installation will run throughout the day. Geiger is the delivering concrete.
Misc
Informational
12/05/2020
12/5/20 Saturday 8:20 AM Contractor covered curbs with blankets ( cold weather specifications) and testing cylinders on 12/4/20 Friday
Misc
Informational
12/08/2020
12/8/20 Tuesday 9:55 AM Contractor (Freedom Concrete) is pouring curb throats for the storm boxes starting at NE Freehold Drive and continuing throughout the project.
Pavement-Proof Roll Partial 12/08/2020
Misc
Informational
12/08/2020
12/8/20 Tuesday 2:15 PM Proof Roll passed inspection.
Grading/Excavation/Fill Inspection Partial 12/09/2020
Misc
Informational
12/09/2020
12/8/20 Tuesday Contractor continue to grade site.
Pavement-Aggregate Base Partial 12/09/2020
Misc
Informational
11/20/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
11/20/2020
11/19/20 Thursday Contractor (Spaulding) continues laying base rock on streets over treated sub grade.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor (Spaulding Const.) continued preparing streets that were base rocked.
Misc
Informational
12/09/2020
12/8/20 Tuesday Contractor ( Superior Boeing ) began installation of base asphalt on project, temperatures were in the low 60’s when work began. Contractor will more than like have to complete base asphalt tomorrow due to the Sunset at 4:50PM today. I will collect the first and last asphalt ticket at the end of the workday.
Pavement-Aggregate Base Partial 12/10/2020
Misc
Informational
12/09/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
12/09/2020
11/19/20 Thursday Contractor (Spaulding) continues laying base rock on streets over treated sub grade.
Misc
Informational
12/09/2020
11/20/20 Friday Contractor (Spaulding Const.) continued preparing streets that were base rocked.
Misc
Informational
12/09/2020
12/8/20 Tuesday Contractor ( Superior Boeing ) began installation of base asphalt on project, temperatures were in the low 60’s when work began. Contractor will more than like have to complete base asphalt tomorrow due to the Sunset at 4:50PM today. I will collect the first and last asphalt ticket at the end of the workday.
Misc
Informational
12/10/2020
12/10/20 Thursday (Yesterday report actual was 12/9/20 Wednesday not 12/8/20 Tuesday) The first asphalt base aggregate base truck arrived around 8:00AM. After base is laid on NE Freehold Drive Plans calls for another lift of asphalt base aggregate then the asphalt surface aggregate will be started.
Pavement-Aggregate Base Passed 12/10/2020
Misc
Informational
12/10/2020
11/18/20 Wednesday Contractor began to install base rock on project streets starting at NE Jamestown Drive.
Misc
Informational
12/10/2020
11/19/20 Thursday Contractor (Spaulding) continues laying base rock on streets over treated sub grade.
Misc
Informational
12/10/2020
11/20/20 Friday Contractor (Spaulding Const.) continued preparing streets that were base rocked.
Misc
Informational
12/10/2020
12/8/20 Tuesday Contractor ( Superior Boeing ) began installation of base asphalt on project, temperatures were in the low 60’s when work began. Contractor will more than like have to complete base asphalt tomorrow due to the Sunset at 4:50PM today. I will collect the first and last asphalt ticket at the end of the workday.
Misc
Informational
12/10/2020
12/10/20 Thursday (Yesterday report actual was 12/9/20 Wednesday not 12/8/20 Tuesday) The first asphalt base aggregate base truck arrived around 8:00AM. After base is laid on NE Freehold Drive Plans calls for another lift of asphalt base aggregate then the asphalt surface aggregate will be started.
Misc
Informational
12/10/2020
COMPLETED
Pavement-Surface Passed 12/10/2020
Misc
Informational
12/10/2020
12/10/20 Thursday Surface asphalt was completed.
Storm Sewer Construction Inspection Partial 12/16/2020
Misc
Informational
11/20/2020
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
11/20/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
11/20/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
11/20/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
11/20/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
11/20/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
11/20/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
11/20/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
11/20/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
11/20/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
11/20/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
11/20/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
11/20/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
11/20/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
11/20/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
11/20/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
11/20/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
11/20/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
11/20/2020
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
11/20/2020
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
11/20/2020
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
12/16/2020
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Water Line - Construction Inspection Partial 12/16/2020
Misc
Informational
10/19/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
10/19/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/16/2020
12/16/20 Wednesday Contractor ( Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Water Line - Construction Inspection Partial 12/17/2020
Misc
Informational
12/16/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/16/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/16/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/17/2020

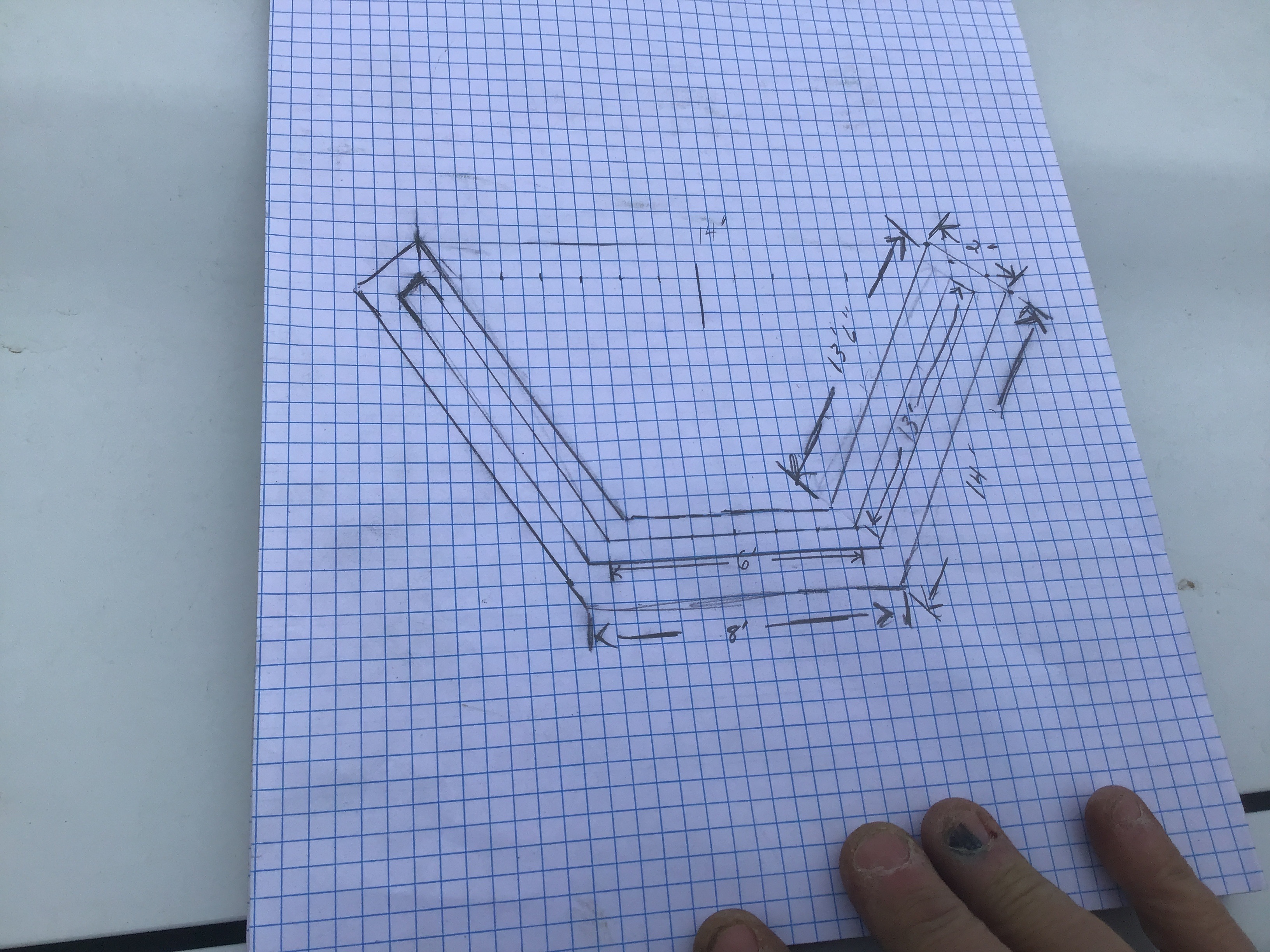

12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Water Line - Construction Inspection Partial 12/17/2020
Misc
Informational
12/17/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/17/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/17/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/17/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/17/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Water - Material Verification Passed 12/17/2020
Misc
Informational
08/27/2020
8/27/20 Thursday Verified Sanitary Manholes, metal and concrete extension rings and lids. See documents.
Misc
Informational
12/17/2020
12/17/20 Thursday Verified Water Pipe, fittings & 12” Valves. See project documents.
Storm - Material Verification Passed 12/17/2020
Misc
Informational
12/17/2020
12/17/20 Thursday Verification of materials was done on 8/27/20 it was reported in (Water Materials Verification) was passed.
Water Line - Construction Inspection Partial 12/17/2020
Misc
Informational
12/17/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/17/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/17/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/17/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/17/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/17/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Grading/Excavation/Fill Inspection Partial 12/17/2020
Misc
Informational
11/13/2020
10/21/20 Wednesday Contractor (Spaulding) grading site and started late last week.
Misc
Informational
11/13/2020
10/22/20 Thursday Contractor continue to Grade and Excavate site.
Misc
Informational
11/13/2020
11/13/20 Friday Contractor continued to Grade and Excavate site for detention basins and street.
Misc
Informational
12/17/2020
12/17/20 Thursday Contractor is now excavating and hauling soil to off site location. There has been grading going on of the project retention basin and adjacent surrounding area ( off & on ) for the past month.
Water Line - Construction Inspection Partial 12/18/2020
Misc
Informational
12/17/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/17/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/17/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/17/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/17/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/17/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/18/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Water Line - Construction Inspection Partial 12/21/2020
Misc
Informational
12/18/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/18/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/18/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/18/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/18/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/18/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/18/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
12/21/2020
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Water Line - Construction Inspection Partial 12/22/2020
Misc
Informational
12/21/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/21/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/21/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/21/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/21/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/21/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/21/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
12/21/2020
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
12/22/2020
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Water Line - Construction Inspection Partial 12/23/2020
Misc
Informational
12/22/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/22/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/22/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/22/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/22/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/22/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/22/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
12/22/2020
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
12/22/2020
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
12/23/2020
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
12/23/2020
12/23/20 Wednesday 11:30PM Contractor installed approximately 200’ of 12” PVC water from Sta. 9+50 to 11+50 as-per project plans.
Water Line - Construction Inspection Partial 12/30/2020
Misc
Informational
12/23/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/23/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/23/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/23/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/23/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/23/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/23/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
12/23/2020
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
12/23/2020
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
12/23/2020
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
12/30/2020
12/30/20 Wednesday 11:10AM On 12/28/20 contractor installed approximately 150’ of 12” PVC line #2 which end with the installation of Fire Hydrant @12+93.19. Contractor poured thrust blocks bends on lines #1 & #2 .
Water Line - Construction Inspection Partial 01/11/2021
Misc
Informational
12/30/2020
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
12/30/2020
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
12/30/2020
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
12/30/2020
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
12/30/2020
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
12/30/2020
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
12/30/2020
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
12/30/2020
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
12/30/2020
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
12/30/2020
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
12/30/2020
12/30/20 Wednesday 11:10AM On 12/28/20 contractor installed approximately 150’ of 12” PVC line #2 which end with the installation of Fire Hydrant @12+93.19. Contractor poured thrust blocks bends on lines #1 & #2 .
Misc
Informational
01/11/2021
1/11/21 Monday 4:20 PM Contractor didn’t notify me that they would be on site. (So my inspection will run late all overtime for this day will be charge to this project.) Approximately 30’ of 12 PVC on line #1 Sta. 12+17 was installed just short of the tie-in point to existing water main. Contractor installed mega lugs for straddle block as-per project plans. Contractor was informed they needs to clean street of track mud in the street.
Water Line - Construction Inspection Partial 01/12/2021
Misc
Informational
01/11/2021
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
01/11/2021
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
01/11/2021
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
01/11/2021
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
01/11/2021
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
01/11/2021
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
01/11/2021
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
01/11/2021
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
01/11/2021
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
01/11/2021
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
01/11/2021
12/30/20 Wednesday 11:10AM On 12/28/20 contractor installed approximately 150’ of 12” PVC line #2 which end with the installation of Fire Hydrant @12+93.19. Contractor poured thrust blocks bends on lines #1 & #2 .
Misc
Informational
01/11/2021
1/11/21 Monday 4:20 PM Contractor didn’t notify me that they would be on site. (So my inspection will run late all overtime for this day will be charge to this project.) Approximately 30’ of 12 PVC on line #1 Sta. 12+17 was installed just short of the tie-in point to existing water main. Contractor installed mega lugs for straddle block as-per project plans. Contractor was informed they needs to clean street of track mud in the street.
Misc
Informational
01/12/2021
1/12/21 Tuesday Contractor will have installed approximately 60’ of 12” PVC water pipe on Line #1 & 60’ on Line #2. Contractor also will pour Three straddle block as per plan. Contractor (Chad of Holthouse the owner) was informed that he needs to deliver as-built for the massive unauthorized changes to Water Line #1. I will not perform inspection that allow the contractor to Tie-in to existing water main until the updates to the as-built of Water Line #1.
Water Line - Construction Inspection Partial 01/13/2021
Misc
Informational
01/12/2021
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
01/12/2021
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
01/12/2021
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
01/12/2021
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
01/12/2021
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
01/12/2021
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
01/12/2021
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
01/12/2021
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
01/12/2021
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
01/12/2021
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
01/12/2021
12/30/20 Wednesday 11:10AM On 12/28/20 contractor installed approximately 150’ of 12” PVC line #2 which end with the installation of Fire Hydrant @12+93.19. Contractor poured thrust blocks bends on lines #1 & #2 .
Misc
Informational
01/12/2021
1/11/21 Monday 4:20 PM Contractor didn’t notify me that they would be on site. (So my inspection will run late all overtime for this day will be charge to this project.) Approximately 30’ of 12 PVC on line #1 Sta. 12+17 was installed just short of the tie-in point to existing water main. Contractor installed mega lugs for straddle block as-per project plans. Contractor was informed they needs to clean street of track mud in the street.
Misc
Informational
01/12/2021
1/12/21 Tuesday Contractor will have installed approximately 60’ of 12” PVC water pipe on Line #1 & 60’ on Line #2. Contractor also will pour Three straddle block as per plan. Contractor (Chad of Holthouse the owner) was informed that he needs to deliver as-built for the massive unauthorized changes to Water Line #1. I will not perform inspection that allow the contractor to Tie-in to existing water main until the updates to the as-built of Water Line #1.
Misc
Informational
01/13/2021
1/13/21 Wednesday Contractor installed All-thread on 45 deg bends on 8” water main Sta. 5+30 line #1 just East of the 8”cross (Sta. 5+28.95 Line #1 to Sta. 7+83.79 Line #2). Contractor backfilled excavation of 8” cross and Lines #1 & 2.
Storm Sewer Construction Inspection Partial 01/14/2021
Misc
Informational
12/16/2020

Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
12/16/2020
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
12/16/2020
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
12/16/2020
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
12/16/2020
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
12/16/2020
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
12/16/2020
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
12/16/2020
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
12/16/2020
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
12/16/2020
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
12/16/2020
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
12/16/2020
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
12/16/2020
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
12/16/2020
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
12/16/2020
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
12/16/2020
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
12/16/2020
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
12/16/2020
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
12/16/2020
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
12/16/2020
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
12/16/2020
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
12/16/2020
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/14/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Storm Sewer Construction Inspection Partial 01/14/2021
Misc
Informational
01/14/2021
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
01/14/2021
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
01/14/2021
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
01/14/2021
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
01/14/2021
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
01/14/2021
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
01/14/2021
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
01/14/2021
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
01/14/2021
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
01/14/2021
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
01/14/2021
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
01/14/2021
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
01/14/2021
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
01/14/2021
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
01/14/2021
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
01/14/2021
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
01/14/2021
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
01/14/2021
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
01/14/2021
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
01/14/2021
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
01/14/2021
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
01/14/2021
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/14/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Misc
Informational
01/14/2021

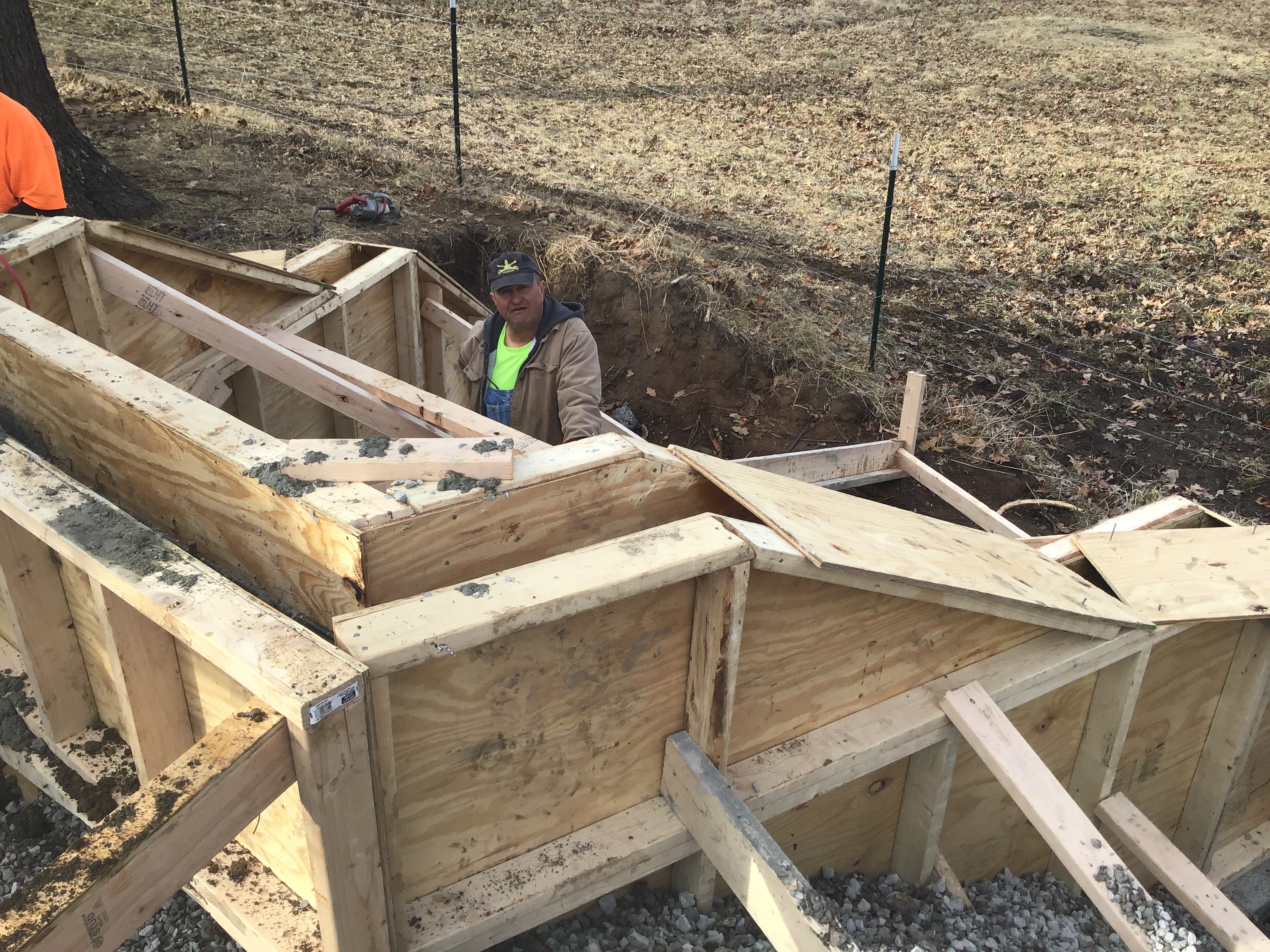

1/14/21 Thursday 3:50PM Contractor Started forming Concrete Head Wall .
Water Line - Hydrostatic Test Passed 01/18/2021
Misc
Informational
01/18/2021
1/18/21 Monday Hydrostatic test 150psi of water main ( Marty Crew).
Water Line - Construction Inspection Passed 01/18/2021
Misc
Informational
01/13/2021
Contractor began to bore across I- 470 from the South side to the North side. Contractor put together 12” Certa-Lok for the installation after the boring is complete(Project site North side of I-470). Thrust blocks were poured on hydrants and fittings that were installed. Contractor is waiting for more piping to be delivered to continue installation of piping head North on the South side of I-470 Hwy This on the wrong project! It should be on Paragon Star.
Misc
Informational
01/13/2021
10/19/20 Monday Street crossing for Lines 1 & 2 have be installed.
Misc
Informational
01/13/2021
12/16/20 Wednesday Contractor (Brain of Holthouse Construction) excavated water line crossing at line #1 to began water line installation of project. Material Verification once material arrive on site.
Misc
Informational
01/13/2021
12/17/20 Thursday 8:15AM Contractor began installed 12”x12” Crossing for LInes #1 & 2.
Misc
Informational
01/13/2021
12/17/20 Thursday 12:32PM Contractor installed approximately 275’ of 12” PVC water main on Line # 2 from Sta 7+83.79 12”X12” cross to approximately Sta 5+03.
Misc
Informational
01/13/2021
12/17/20 Thursday 3:20PM Contractor installed approximately 150’ more feet of 12” PVC water main on line #2. Contractor stopped around Sta 3+50 for the evening. Contractor backfilled excavation of installed water pipe and fenced off the 12”X12” Cross @ NE Freehold Drive & NE Jamestown Drive.
Misc
Informational
01/13/2021
12/18/20 Friday Contractor installed approximately 350 of 12” PVC of water main on Line #2 Stopping @ the Sta 0+41 A 45 deg bend. Starting from the Cross 12”x12” on Line #1 6+28.96 12” PVC (Sta 7+83.79 Line #2). Approximately 170’ of 12” PVC was installed on Line #1.
Misc
Informational
01/13/2021
Contractor (Holthouse/Brain’s crew) installed approximately 320’ of 12” PVC water main on Line #1 and four 11 1/4 bends (as-per plans).
Misc
Partial Correction
01/13/2021
Contractor (Holthouse/Brain’s crew) contractor replaced 22 1/2 bends with 11 1/4 bends and move the location 10’ West of Storm Line @ 8+40 and the second 12’ to the East 8+40 on LIne #1. Also the 45 degree bends where not used but the 18”of clearance was achieved. Contractor did not consult the inspector when on waterline were made the changes to the depth of pipe.
Misc
Informational
01/13/2021
12/23/20 Wednesday 9:12AM Contractor (Holthouse Talked with Chad) about the unapproved field changes that were made. Chad talked with the Engineer Solutions and they well due the field survey. The inspector has observed no structural problem with redesign, but wants the contractor to submit changes so they can be properly recorded and approved. I will inform the City review Engineer of the field changes that were made to fittings and elevation throughout Line #1.
Misc
Informational
01/13/2021
12/30/20 Wednesday 11:10AM On 12/28/20 contractor installed approximately 150’ of 12” PVC line #2 which end with the installation of Fire Hydrant @12+93.19. Contractor poured thrust blocks bends on lines #1 & #2 .
Misc
Informational
01/13/2021
1/11/21 Monday 4:20 PM Contractor didn’t notify me that they would be on site. (So my inspection will run late all overtime for this day will be charge to this project.) Approximately 30’ of 12 PVC on line #1 Sta. 12+17 was installed just short of the tie-in point to existing water main. Contractor installed mega lugs for straddle block as-per project plans. Contractor was informed they needs to clean street of track mud in the street.
Misc
Informational
01/13/2021
1/12/21 Tuesday Contractor will have installed approximately 60’ of 12” PVC water pipe on Line #1 & 60’ on Line #2. Contractor also will pour Three straddle block as per plan. Contractor (Chad of Holthouse the owner) was informed that he needs to deliver as-built for the massive unauthorized changes to Water Line #1. I will not perform inspection that allow the contractor to Tie-in to existing water main until the updates to the as-built of Water Line #1.
Misc
Informational
01/13/2021
1/13/21 Wednesday Contractor installed All-thread on 45 deg bends on 8” water main Sta. 5+30 line #1 just East of the 8”cross (Sta. 5+28.95 Line #1 to Sta. 7+83.79 Line #2). Contractor backfilled excavation of 8” cross and Lines #1 & 2.
Misc
Informational
01/18/2021
1/18/21 Monday MLK Day Contractor chlorinated the water line main finished @ 2:15PM.
Storm Sewer Construction Inspection Partial 01/18/2021
Misc
Informational
01/14/2021
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
01/14/2021
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
01/14/2021
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
01/14/2021
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
01/14/2021
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
01/14/2021
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
01/14/2021
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
01/14/2021
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
01/14/2021
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
01/14/2021
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
01/14/2021
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
01/14/2021
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
01/14/2021
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
01/14/2021
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
01/14/2021
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
01/14/2021
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
01/14/2021
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
01/14/2021
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
01/14/2021
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
01/14/2021
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
01/14/2021
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
01/14/2021
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/14/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Misc
Informational
01/14/2021
1/14/21 Thursday 3:50PM Contractor Started forming Concrete Head Wall .
Misc
Informational
01/18/2021
1/18/21 Monday MLK Day Contractor poured footing for Head Wall and floor on 1/14/21. Contractor created forms for the the wings and walls for the Head Wall.
Water Line - Construction Inspection Passed 01/19/2021
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor De-Chlorinated waterline.
Storm Sewer Construction Inspection Partial 01/19/2021
Misc
Informational
01/18/2021
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
01/18/2021
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
01/18/2021
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
01/18/2021
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
01/18/2021
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
01/18/2021
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
01/18/2021
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
01/18/2021
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
01/18/2021
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
01/18/2021
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
01/18/2021
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
01/18/2021
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
01/18/2021
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
01/18/2021
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
01/18/2021
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
01/18/2021
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
01/18/2021
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
01/18/2021
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
01/18/2021
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
01/18/2021
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
01/18/2021
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
01/18/2021
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/18/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Misc
Informational
01/18/2021
1/14/21 Thursday 3:50PM Contractor Started forming Concrete Head Wall .
Misc
Informational
01/18/2021
1/18/21 Monday MLK Day Contractor poured footing for Head Wall and floor on 1/14/21. Contractor created forms for the the wings and walls for the Head Wall.
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor formed and poured Head Wall for outlet storm pipe as-per plan.
Misc
Informational
01/19/2021
1/19/21 Tuesday 4:10PM On line 700 Installed approximately 200’ of 60” RCP and structures 705 & 706. Collars were poured on 704 & 705.
Misc
Informational
01/19/2021
1/19/21 Tuesday 4:40PM On (Second crew) Line 2200 installed approximately 340’ of 42” corrugated HDPE storm pipe and Construction 6’x4’’ Grate Inlet 2201 & 5’x4’ Grate Inlet 2202. Invert and collars were poured on Grate Inlet 2201.
Storm Sewer Construction Inspection Partial 01/20/2021
Misc
Informational
01/19/2021
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
01/19/2021
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
01/19/2021
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
01/19/2021
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
01/19/2021
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
01/19/2021
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
01/19/2021
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
01/19/2021
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
01/19/2021
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
01/19/2021
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
01/19/2021
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
01/19/2021
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
01/19/2021
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
01/19/2021
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
01/19/2021
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
01/19/2021
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
01/19/2021
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
01/19/2021
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
01/19/2021
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
01/19/2021
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
01/19/2021
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
01/19/2021
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/19/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Misc
Informational
01/19/2021
1/14/21 Thursday 3:50PM Contractor Started forming Concrete Head Wall .
Misc
Informational
01/19/2021
1/18/21 Monday MLK Day Contractor poured footing for Head Wall and floor on 1/14/21. Contractor created forms for the the wings and walls for the Head Wall.
Misc
Informational
01/19/2021
1/19/21 Tuesday Contractor formed and poured Head Wall for outlet storm pipe as-per plan.
Misc
Informational
01/20/2021
1/20/21 Wednesday Contractor removed setting forms for the Head Wall. Contractor continued to grade area to match corrugated outlet pipes & structures and install Rip-Rap as-per plan.
Storm Sewer Construction Inspection Partial 01/29/2021
Misc
Informational
01/20/2021
Contractor preparing site for installation of storm sewer as-per plan.
Misc
Informational
01/20/2021
10/1/20 Thursday Contractor installed Curb Inlet 2-2 and 80’ of 24” HDPE on 9/30/20 Wednesday. Curb inlet 2-3, 2-4, & 2-5 were set in place today approximately 75’ of 24” HDPE, 34’ of 18” HDPE, 103’ of RCP was installed.
Misc
Informational
01/20/2021
10/2/20 Friday Holthouse Installed approximately 140’ of 15” HDPE pipe on Storm Line 2 and set Curb Inlet 2-6. Contractor is scheduled to pour inverts for Curb Inlet that were installed.
Misc
Informational
01/20/2021
10/5/20 Monday Contractor installed the base of Curb Inlet 4-1 and 34’ of 15” HDPE pipe. Soil test company Interter PSI tested street crossing for utilities that were installed (storm & sanitary). Contractor poured inverts on Curb Inlets.
Misc
Informational
01/20/2021
10/6/20 Tuesday Contractor installed the Storm Line #3 & Curb Inlet 3-1. PSI continued testing of utilities crossing streets.
Misc
Informational
01/20/2021
10/7/20 Wednesday Contractor installed Curb Inlet 2-6 & 2-7 and 34’ of 15” HDPE pipe from the two Curb Inlets. Contractor has installed Curb Inlet 5-2 base and ready to install 24” HDPE pipe. 179’ of 24” HDPE pipe was installed for Storm Line 5. Inverts and collars were poured for Curb Inlets that were installed yesterday and today.
Misc
Informational
01/20/2021
10/8/20 Thursday Contractor installed Curb Inlets 5-3 and 140’ of 18” HDPE storm pipe on Line 5. Curb Inlets 7-2 and 7-3 were installed and approximately 100’ of 18”HDPE storm pipe Line 7. The owner of the construction company schedule the haphazard construct of Storm Lines due to a back-up in supply by his supplier ( Possible Covid related).
Misc
Informational
01/20/2021
10/9/20 Friday Contractor installed Curb Inlet 7-4 and approximately 42’ of 15” RCP pipe on Line 7.
Misc
Informational
01/20/2021
10/12/20 Monday Contractor installed approximately 173’ of 15” HDPE & 40’ of 15” RCP on Storm Line 1. Curb Inlet 1-2 &1-3 was installed on Storm Line 1. Curb Inlet 6-3 & 6-4 and approximately 45’ of 24” RCP was installed on Storm Line 6. Collars were poured on the Inlet that were installed on Storm Line 1&6.
Misc
Informational
01/20/2021
10/13/20 Tuesday Contractor installed approximately 120’ of 24” HDPE from Curb Inlet 6-3 toward where Field Inlet 6-2 will be installed. Approximately 120’ of 18” HDPE from Curb Inlet 6-4 to where Field Inlet 6-5 will be installed. Contractor poured collars and inverts on Curb Inlet that were installed.
Misc
Informational
01/20/2021
10/14/20 Wednesday Storm Line 6 Field Inlet 6-5 and Curb Inlet 6-8 & 6-9 were installed. Approximately 38’ of 15” HDPE was installed between Curb Inlet 6-8 & 6-9. Concrete to pour collars and inverts set for tomorrow.
Misc
Informational
01/20/2021
10/15/20 Contractor began installing piping on Storm line 6 as per project details.
Misc
Informational
01/20/2021
10/16/20 Friday Contractor completed installation of Storm Line 6 except for the Field Inlet 6-2 and Flared End 6-1.
Misc
Informational
01/20/2021
10/19/20 Monday Contractor began installing 24” HDPE Storm Line form Curb Inlet 2-2 to the Flared End Section 2-1. Invert and collars were poured on previous installed Inlets.
Misc
Informational
01/20/2021
10/21/20 Wednesday Contractor finished installation of Storm Lines 2 & 6 10/20/20 Tuesday. Contractor has restarted installation of Storm Line 5 @ Field Inlet 5-4. Inclement weather stop work on site shortly after 11:00AM.
Misc
Informational
01/20/2021
10/22/20 Thursday Contractor continued work on Storm Line 5. Contractor received lids for some field inlets and began to set them.
Misc
Informational
01/20/2021
10/28/20 Wednesday Contractor received more Storm lids to install on storm Field Inlets.
Misc
Informational
01/20/2021
11/2/20 Monday Contractor installed storm line 5 and install storm field inlet lids that were delivered.
Misc
Informational
01/20/2021
11/18/20 Wednesday Contractor installed corrugated piping between detention basins.
Misc
Informational
01/20/2021
11/19/20 Thursday Contractor continues to install storm pipe for basins. Contractor (Holthouse) is installing Head Wall 9-1 & Miter End 9-2 See Details Sheet C. 306. Storm piping will be shorten going to the basin on Lines 5 to be determined, 6 by 6.5’ & 10 by 6’. All changes will be reflected on as built. Contractor will be working on installation of Rip Rap on storm piping leading to from basins per project plans.
Misc
Informational
01/20/2021
11/20/20 Friday Contractor installing Under Drain Storm 1-2, 5-2 see details 203 & 600 sheet. Continued to inspect construction connection of the two Under Drain on NE Jamestown Drive.
Misc
Informational
01/20/2021
12/16/20 Wednesday Contractor ( Brain from Holthouse ) began grouting Storm inlet boxes that were installed. Spaulding has been grading Retention Baisins on project since last week on approximately date 12/8/20.
Misc
Informational
01/20/2021
1/14/21 Thursday Contractor (Brain crew Holthouse) began forming the footing for the Head Wall (see 9-1 Details Sheet C. 306 and Hand Drawing documents See this date 1/14/21).
Misc
Informational
01/20/2021
1/14/21 Thursday 3:50PM Contractor Started forming Concrete Head Wall .
Misc
Informational
01/20/2021
1/18/21 Monday MLK Day Contractor poured footing for Head Wall and floor on 1/14/21. Contractor created forms for the the wings and walls for the Head Wall.
Misc
Informational
01/20/2021
1/19/21 Tuesday Contractor formed and poured Head Wall for outlet storm pipe as-per plan.
Misc
Informational
01/20/2021
1/20/21 Wednesday Contractor removed setting forms for the Head Wall. Contractor continued to grade area to match corrugated outlet pipes & structures and install Rip-Rap as-per plan.
Misc
Informational
01/29/2021
1/29/21 Thursday Contractor pulled forms off the Head Wall.
Water Line - Construction Inspection Partial 02/02/2021
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor ( Brian/Holthouse ) performed tie-in at the three location as-per project plans.
Water Line - Construction Inspection Partial 02/03/2021
Misc
Informational
02/02/2021
2/2/21 Tuesday Contractor ( Brian/Holthouse ) performed tie-in at the three location as-per project plans.
Misc
Informational
02/03/2021
2/3/21 Wednesday Contractor ( Brain/Holthouse ) fixings the rubber seal gasket on the Fire Hydrant at NE Freehold Dr. & NE Goshen Dr. that was broken when the hydrant was turned.
Erosion Control Inspection Partial 02/03/2021
Misc
Informational
02/03/2021
Contractor has maintained construction entrance we will continue to monitor site to ensure sediment doesn’t leave the site.
Misc
Informational
02/03/2021

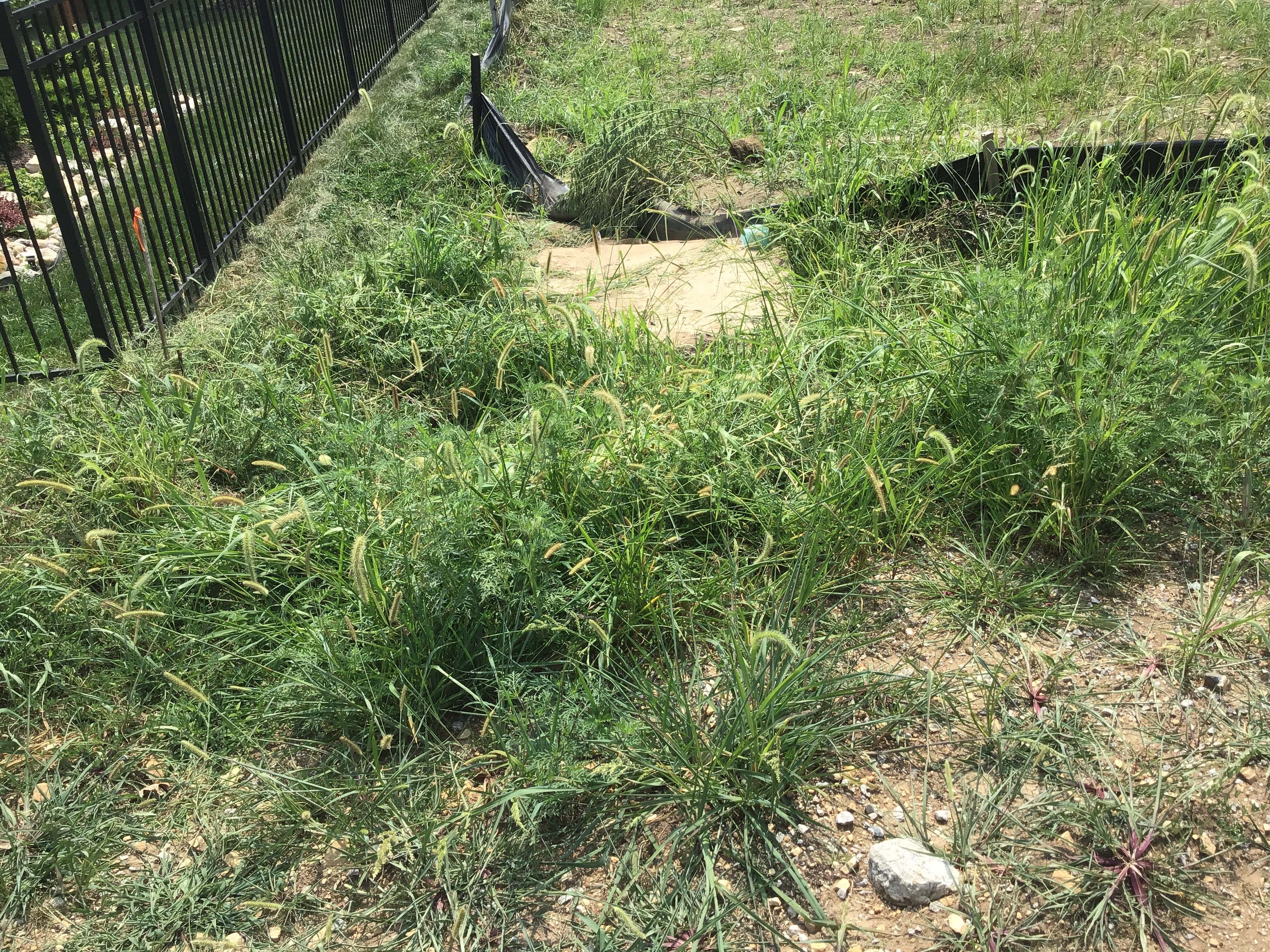

2/3/21 Wednesday Erosion controlled failed - sediment around the site and gutter buddies have not been installed.
Erosion Control Inspection Partial 03/18/2021
Misc
Informational
08/18/2020
8/17/20 Monday Silt Fence appeared to be properly installed work site. I will continue to monitor silt fence to ensure it maintain its effectiveness.
Misc
Corrective Action Required
03/18/2021
3/18/21 Thursday Numerous gutter buddies where filled with soil and need to be clean.
Record Drawing Review Passed 2/19/2021 04/26/2021
Misc
Informational
04/26/2021

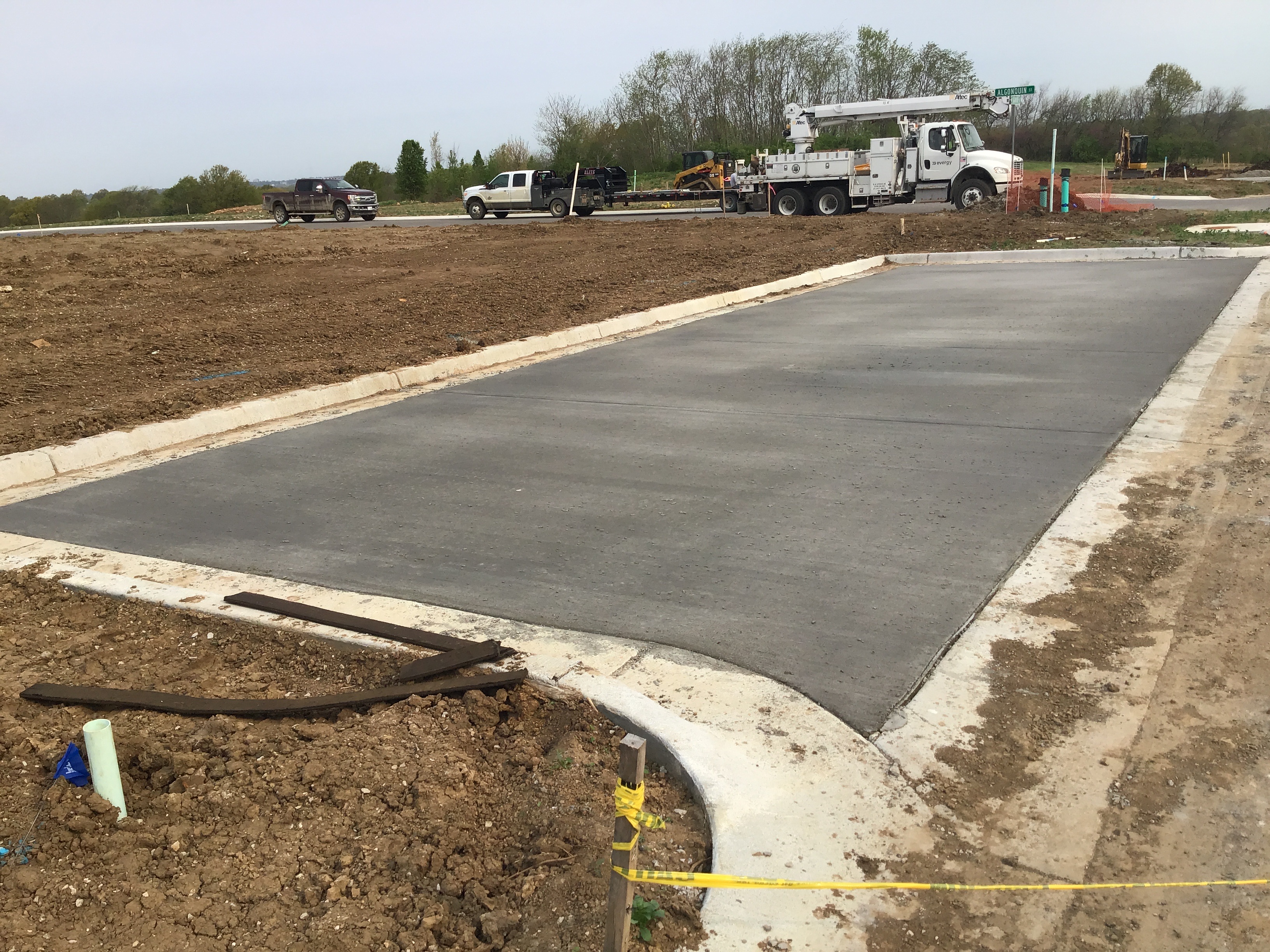

4/26/21 Monday Parking area - concrete poured with standard mix.
Record Drawing Review Passed 3/5/2021 04/26/2021
Misc
Informational
04/26/2021
Parking area - concrete was poured with standard mix.
Pavement-Surface Passed 04/27/2021
Misc
Informational
04/27/2021
4/27/21 Tuesday Contractor poured concrete surface for the two parking Lot areas on 4/26/21 Monday. See pic of finished surfaces.
Erosion Control Inspection Failed 05/19/2021
Misc
Informational
03/18/2021
Contractor has maintained construction entrance we will continue to monitor site to ensure sediment doesn’t leave the site.
Misc
Informational
03/18/2021
2/3/21 Wednesday Erosion controlled failed - sediment around the site and gutter buddies have not been installed. 5/16/21 Wednesday Erosion controlled failed - along NE Jamestown gutter buddies need to be clean out and heavy silt in the street.
Site Visit Partial 08/04/2021
Misc
Informational
08/04/2021
Possible that storm drain may require maintenance, Steve Robbins received a call from the resident at 4828 NE Jamestown Rd. The existing field inlet needs to be clean out & build a protection around it. The culvert that discharges into the retention basin that is in the rear of property needs to be clean out. See pics for the day.
Sidewalk Inspection Partial 9/7/2021 9/7/2021 09/07/2021
Misc
Informational
09/07/2021

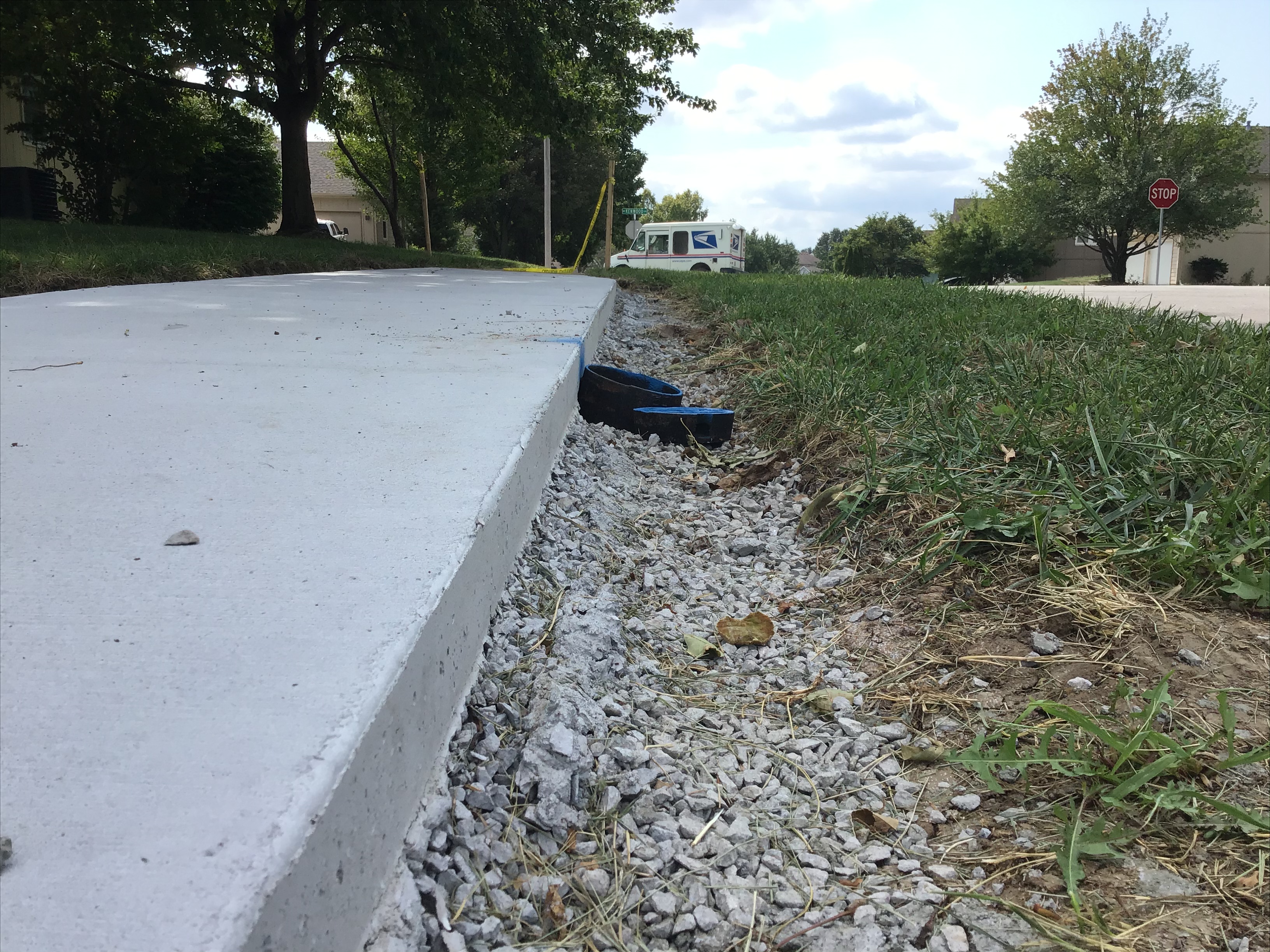

Common Ground and ADA Ramps 9/7/21 10:45 - The sidewalks on Jamestown was poured when we arrived on site, spoke to contractor and he told me they are under 1.5% for slope. Did another inspection for the 35 ft on Freehold Dr, and spoke with the contractor about the ADA ramps on Freehold Dr and Jamestown. 14:30 - Sidewalk is ada compliant, told the contractor to fix a minor issue on the SW corner ramp was reading 8.6% told him to drop it down to 8.3%.
Sidewalk Inspection Failed 9/14/2021 9/14/2021 09/14/2021
Misc
Informational
09/07/2021
Common Ground and ADA Ramps 9/7/21 10:45 - The sidewalks on Jamestown was poured when we arrived on site, spoke to contractor and he told me they are under 1.5% for slope. Did another inspection for the 35 ft on Freehold Dr, and spoke with the contractor about the ADA ramps on Freehold Dr and Jamestown. 14:30 - Sidewalk is ada compliant, told the contractor to fix a minor issue on the SW corner ramp was reading 8.6% told him to drop it down to 8.3%.
Misc
Corrective Action Required
09/14/2021
9-14-21 12:15. Did sidewalk inspections for commen ground at Monticello. Valve 1200 NE Kenwood dr needs to relocated and raise to match grade. ( Pics are attached as Water valve at 1200 ne kenwood dr #1 & 2. ). Roughly 120 ft of sidewalk has failed at the common ground of 4712 NE Jamestown dr . Sidewalk is carrying over 2% slope through the 120 ft. ( Pic attached as Failed side walk at 4712 NE Jamestown Dr) Sidewalk has failed at the first panel going in to the ADA at 4740 NE Freehold Dr. The panel is carrying 8.6% slope of grade ( No Pic )
Sidewalk Inspection Partial 9/17/2021 9/17/2021 09/17/2021
Misc
Informational
09/14/2021
Common Ground and ADA Ramps 9/7/21 10:45 - The sidewalks on Jamestown was poured when we arrived on site, spoke to contractor and he told me they are under 1.5% for slope. Did another inspection for the 35 ft on Freehold Dr, and spoke with the contractor about the ADA ramps on Freehold Dr and Jamestown. 14:30 - Sidewalk is ada compliant, told the contractor to fix a minor issue on the SW corner ramp was reading 8.6% told him to drop it down to 8.3%.
Misc
Corrective Action Required
09/14/2021
9-14-21 12:15. Did sidewalk inspections for commen ground at Monticello. Valve 1200 NE Kenwood dr needs to relocated and raise to match grade. ( Pics are attached as Water valve at 1200 ne kenwood dr #1 & 2. ). Roughly 120 ft of sidewalk has failed at the common ground of 4712 NE Jamestown dr . Sidewalk is carrying over 2% slope through the 120 ft. ( Pic attached as Failed side walk at 4712 NE Jamestown Dr) Sidewalk has failed at the first panel going in to the ADA at 4740 NE Freehold Dr. The panel is carrying 8.6% slope of grade ( No Pic )
Misc
Informational
09/17/2021
Went out with two levels and verified that the sidewalks and ADA ramps are both in spec. Water valve is being relocated and will reinspect.
Erosion Control Inspection Failed 10/13/2021 10/13/2021 10/13/2021
Misc
Informational
05/19/2021
Contractor has maintained construction entrance we will continue to monitor site to ensure sediment doesn’t leave the site.
Misc
Informational
05/19/2021
2/3/21 Wednesday Erosion controlled failed - sediment around the site and gutter buddies have not been installed. 5/16/21 Wednesday Erosion controlled failed - along NE Jamestown gutter buddies need to be clean out and heavy silt in the street.
Misc
Corrective Action Required
10/13/2021
10-13-21 AN Erosion controlled failed - sediment around the site and gutter buddies need to be cleaned. Tell all contractors to get erosion control in place. ALL STREETS NEED TO BE CLEANED UP!!
Sidewalk Inspection Passed 11/22/2021 11/22/2021 11/22/2021
Misc
Resolved
10/18/2021
Common Ground and ADA Ramps 9/7/21 10:45 - The sidewalks on Jamestown was poured when we arrived on site, spoke to contractor and he told me they are under 1.5% for slope. Did another inspection for the 35 ft on Freehold Dr, and spoke with the contractor about the ADA ramps on Freehold Dr and Jamestown. 14:30 - Sidewalk is ada compliant, told the contractor to fix a minor issue on the SW corner ramp was reading 8.6% told him to drop it down to 8.3%.
Misc
Resolved
10/18/2021
9-14-21 12:15. Did sidewalk inspections for commen ground at Monticello. Valve 1200 NE Kenwood dr needs to relocated and raise to match grade. ( Pics are attached as Water valve at 1200 ne kenwood dr #1 & 2. ). Roughly 120 ft of sidewalk has failed at the common ground of 4712 NE Jamestown dr . Sidewalk is carrying over 2% slope through the 120 ft. ( Pic attached as Failed side walk at 4712 NE Jamestown Dr) Sidewalk has failed at the first panel going in to the ADA at 4740 NE Freehold Dr. The panel is carrying 8.6% slope of grade ( No Pic )
Misc
Corrective Action Required
10/18/2021
Went out with two levels and verified that the sidewalks and ADA ramps are both in spec. Water valve is being relocated and will reinspect. Valve still needs to be fixed
Water Line - Valve Failed 11/22/2021 11/22/2021 11/22/2021
Miscellaneous Correction
Corrective Action Required
11/22/2021
9-14-21 12:15. Did sidewalk inspections for commen ground at Monticello. Valve 1200 NE Kenwood dr needs to relocated and raise to match grade. ( Pics are attached as Water valve at 1200 ne kenwood dr #1 & 2. ). 11-22-21 10:29 AN water valve still needs to be addressed.
Water Line - Hydrostatic Test Not Ready 03/02/2022
Grading/Excavation/Fill Inspection Passed 03/02/2022
Misc
Informational
12/17/2020
12/8/20 Tuesday Contractor continue to grade site.
Water - Material Verification Passed 03/02/2022
Public Curb Inspection Partial 03/02/2022
Misc
Informational
12/08/2020
12/4/20 Friday 8:30 AM Contractor ( Turner & Michael Const. ) started pouring curbs for the subdivision project. Curb installation will run throughout the day. Geiger is the delivering concrete.
Misc
Informational
12/08/2020
12/5/20 Saturday 8:20 AM Contractor covered curbs with blankets ( cold weather specifications) and testing cylinders on 12/4/20 Friday
Misc
Informational
12/08/2020
12/8/20 Tuesday 9:55 AM Contractor (Freedom Concrete) is pouring curb throats for the storm boxes starting at NE Freehold Drive and continuing throughout the project.
Curb - Proof Roll Passed 03/02/2022
Sanitary Sewer Construction Inspection Passed 03/02/2022
Misc
Informational
11/13/2020
8/28/20 Friday 8:00 AM Contractor (Holthouse- Marty) is cutting wye in existing sanitary Line C and installing newly approved Maxadaptor, starting installation @ Lot 122.
Misc
Informational
11/13/2020
9/2/20 Wednesday Contractor installed three service lines on 9/1/20 Tuesday Lots 136,137, & 147. 9:00 AM Today Contractor has installed wyes and stub lines for Lots 138, & 146 so far. Contractor will pour trench checks for yesterday and today’s stubs. I reminded the Contractor ( Holthouse - Marty ) about rolling the wyes between 30 & 45 degree as specified in the Design Construction Manual!
Misc
Informational
11/13/2020
9/3/20 Thursday Contractor also completed wyes and laterals for Lots 139 & 145 yesterday. 11:00AM Today contractor has completed wye and lateral for Lot 140.
Misc
Informational
11/13/2020
9/4/20 Friday Contractor installed lateral line for Lot 143 and wye and lateral were installed for Lot 142 Maxadaptor was used tie in when there were two wye one amatory was used. Contractor was able to tie-in onside to existing pipe as per specifications. Two sleeve Maxadaptors are used when one wye is being installed (Seedocuments or additions picture associated with this project). Contractor went back to Lot 120 and finished the last 8’ of lateral 4” that was stop due to weather and ground conditions. Contractor has called for flowable fill for trench checks on laterals
Misc
Informational
11/13/2020
9/9/20 9:00AM On 9/8/20 Contractor (Holthouse) installed sanitary laterals with Maxadaptor for Lots 117 and 118 and poured ditch checks. Today contractor is working on working on Lot 119 and 135.
Misc
Informational
11/13/2020
9/15/20 9:00AM Tuesday On 9/14/20 Monday contractor installed sanitary lateral for Lot 135 and excavated existing MH C-6 to core for new sanitary 8” pipe. 9/15/20 Monday coring was completed on MH C-6 and contractor began removal soil from site.
Misc
Informational
11/13/2020
9/15/20 2:30PM Tuesday On 9/15/20 Contractor installed approximately 150’ of 8” sanitary pipe on Line 1.
Misc
Informational
11/13/2020
9/16/20 3:11PM Tuesday On 9/16/20 Contractor installed MH 1-1 and 1-2 on Line 1. Contractor installed approximately 180’ of 8” SDR-26 PVC on Line 1. Laterals were installed on Lot 131 & 132.
Misc
Informational
11/13/2020
9/17/20 Thursday Contractor installed lateral on Lot 130, 133, & 134 and ditch checks were poured with flowable fill.
Misc
Informational
11/13/2020
9/18/20 Friday Contractor finished pouring ditch checks on laterals & completed the install of MH 1-1. Contractor backfill excavation for Line 1. Note: Lateral for Lot 128 was completed on 9/16/20 this is not reflected on my 9/16/20 report.
Misc
Informational
11/13/2020
9/21/20 Monday Contractor (Holthouse Const.) installed 240’ of 8” SDR - 26 8”x4” wye for Lot 148.
Misc
Informational
11/13/2020
9/22/20 Tuesday Contractor Installed approximately 105’ of 8” SDR -26 and laterals to Lot 116, 148 & 149.
Misc
Informational
11/13/2020
9/23/20 Wednesday Contractor (Holthouse Construction) pour trench checks for laterals installed on 9/22/20. Approximately 200’ of 8” SDR- 26 sewer pipe was installed.
Misc
Informational
11/13/2020
9/24/20 Thursday Contractor installed laterals on Lots 115,114 &,113. The bottom half of MH 2-2 was set.
Misc
Informational
11/13/2020
9/25/20 Friday 11:15AM Contractor (Holthouse Const.) installed Lateral lines for Lots 150,151, & 152 for Sanitary line 2.
Misc
Informational
11/13/2020
9/28/20 Monday Contractor installed approximately 180’ of 8” SDR-26, MH 2-3, & Lot 111 on Sanitary Line 2.
Misc
Informational
11/13/2020
9/29/20 Tuesday Contractor installed Laterals for Lot 109, 110, & 153 and the top half of the MH 2-3.
Misc
Informational
11/13/2020
10/27/20 Tuesday Contractor installed Laterals for Lot 122 & 127 and backfilled excavation. Contractor stopped the due to inclement weather.
Misc
Informational
11/13/2020
10/28/20 Wednesday Contractor installed the service Line for Lot 121 from Sanitary Line G is in the easement that runs right by the Lot 121. Contractor will reflect change on as-built. I talk with the engineer before approval was given this will be listed as a field change. 2 Max Adaptor were in on both side of the wye that was installed on existing sanitary Line G.
Misc
Informational
11/13/2020
11/11/20 Wednesday Contractor is pre-test sanitary line for pressure test.
Misc
Informational
11/13/2020
11/13/20 Friday Contractor continued to pre-test and fine any leaks on newly installed Certa - Lock tees.
Install Street and Stop Signs Passed 03/02/2022
ESC - (Vegetation/Ground Cover) Partial 03/02/2022
Storm - Swales Passed 03/02/2022
Sanitary Sewer - Air Test Not Ready 03/02/2022
Sanitary - Material Verification Passed 03/02/2022
Documents & Images
Date Uploaded File Type Document Name
08/07/2020 Receipt Receipt for transaction: 2020-005055
08/11/2020 Approved Plans Monticello, 4th plat Sanitary Approved 8.11.20
08/11/2020 Approved Plans Monticello, 4th plat Street Storm ESC Approved 8.11.20
08/11/2020 Approved Plans Monticello, 4th plat Water Approved 8.11.20
08/13/2020 Letter DE-Permit
08/18/2020 Letter INSPECTION SUMMARY
08/27/2020 image.jpg
08/27/2020 image.jpg0
08/27/2020 image.jpg1
08/27/2020 image.jpg2
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 image.jpg3
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 image.jpg4
08/28/2020 image.jpg5
08/28/2020 image.jpg6
08/28/2020 image.jpg7
08/28/2020 image.jpg8
08/28/2020 Letter INSPECTION SUMMARY
08/28/2020 Letter INSPECTION SUMMARY
09/02/2020 image.jpg9
09/02/2020 image.jpg10
09/02/2020 image.jpg11
09/03/2020 Letter INSPECTION SUMMARY
09/03/2020 image.jpg12
09/03/2020 Letter INSPECTION SUMMARY
09/03/2020 Letter INSPECTION SUMMARY
09/04/2020 Letter INSPECTION SUMMARY
09/09/2020 Letter INSPECTION SUMMARY
09/09/2020 Letter INSPECTION SUMMARY
09/15/2020 Letter INSPECTION SUMMARY
09/15/2020 Letter INSPECTION SUMMARY
09/16/2020 Letter INSPECTION SUMMARY
09/17/2020 Letter INSPECTION SUMMARY
09/17/2020 Letter INSPECTION SUMMARY
09/18/2020 Letter INSPECTION SUMMARY
09/21/2020 Letter INSPECTION SUMMARY
09/22/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/28/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
09/29/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/01/2020 Letter INSPECTION SUMMARY
10/01/2020 image.jpg13
10/01/2020 image.jpg14
10/02/2020 Letter INSPECTION SUMMARY
10/02/2020 Letter INSPECTION SUMMARY
10/05/2020 Letter INSPECTION SUMMARY
10/05/2020 Letter INSPECTION SUMMARY
10/06/2020 Letter INSPECTION SUMMARY
10/07/2020 image.jpg15
10/07/2020 Letter INSPECTION SUMMARY
10/07/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/09/2020 Letter INSPECTION SUMMARY
10/09/2020 Letter INSPECTION SUMMARY
10/12/2020 Letter INSPECTION SUMMARY
10/13/2020 Letter INSPECTION SUMMARY
10/14/2020 Letter INSPECTION SUMMARY
10/15/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/23/2020 Letter INSPECTION SUMMARY
10/27/2020 Letter INSPECTION SUMMARY
10/28/2020 Letter INSPECTION SUMMARY
10/28/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/13/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/18/2020 Letter INSPECTION SUMMARY
11/18/2020 image.jpg16
11/18/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/19/2020 image.jpg17
11/19/2020 image.jpg18
11/19/2020 image.jpg19
11/19/2020 image.jpg20
11/19/2020 Letter INSPECTION SUMMARY
11/19/2020 Letter INSPECTION SUMMARY
11/20/2020 image.jpg21
11/20/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
11/20/2020 Letter INSPECTION SUMMARY
11/30/2020 image.jpg22
11/30/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
11/30/2020 Letter INSPECTION SUMMARY
12/04/2020 image.jpg23
12/04/2020 Letter INSPECTION SUMMARY
12/05/2020 Letter INSPECTION SUMMARY
12/08/2020 image.jpg24
12/08/2020 Letter INSPECTION SUMMARY
12/08/2020 image.jpg25
12/08/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 Letter INSPECTION SUMMARY
12/09/2020 image.jpg26
12/09/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 image.jpg27
12/10/2020 Letter INSPECTION SUMMARY
12/10/2020 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/16/2020 Letter INSPECTION SUMMARY
12/17/2020 image.jpg28
12/17/2020 image.jpg29
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/17/2020 Letter INSPECTION SUMMARY
12/18/2020 Letter INSPECTION SUMMARY
12/21/2020 Letter INSPECTION SUMMARY
12/22/2020 Letter INSPECTION SUMMARY
12/23/2020 image.jpg30
12/23/2020 image.jpg31
12/23/2020 Letter INSPECTION SUMMARY
12/23/2020 Letter INSPECTION SUMMARY
12/30/2020 Letter INSPECTION SUMMARY
01/11/2021 Letter INSPECTION SUMMARY
01/11/2021 Letter INSPECTION SUMMARY
01/12/2021 image.jpg32
01/12/2021 Letter INSPECTION SUMMARY
01/13/2021 image.jpg33
01/13/2021 Letter INSPECTION SUMMARY
01/14/2021 image.jpg34
01/14/2021 image.jpg35
01/14/2021 Letter INSPECTION SUMMARY
01/14/2021 image.jpg36
01/14/2021 Letter INSPECTION SUMMARY
01/14/2021 image.jpg37
01/14/2021 image.jpg38
01/14/2021 Letter INSPECTION SUMMARY
01/18/2021 Letter INSPECTION SUMMARY
01/18/2021 Letter INSPECTION SUMMARY
01/18/2021 Letter INSPECTION SUMMARY
01/19/2021 Letter INSPECTION SUMMARY
01/19/2021 image.jpg39
01/19/2021 image.jpg40
01/19/2021 image.jpg41
01/19/2021 Letter INSPECTION SUMMARY
01/19/2021 image.jpg42
01/19/2021 image.jpg43
01/19/2021 image.jpg44
01/19/2021 Letter INSPECTION SUMMARY
01/20/2021 image.jpg45
01/29/2021 Letter INSPECTION SUMMARY
01/29/2021 Letter INSPECTION SUMMARY
02/02/2021 image.jpg46
02/02/2021 image.jpg47
02/02/2021 image.jpg48
02/02/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 image.jpg49
02/03/2021 image.jpg50
02/03/2021 image.jpg51
02/03/2021 Letter INSPECTION SUMMARY
02/03/2021 Letter INSPECTION SUMMARY
02/04/2021 STREET AND STORM - as-built
02/04/2021 SANITARY - as-built
02/04/2021 WATER - as-built
03/02/2021 STREET AND STORM ASBUILT 3-2-2021
03/18/2021 Letter INSPECTION SUMMARY
04/26/2021 Letter INSPECTION SUMMARY
04/26/2021 Letter INSPECTION SUMMARY
04/26/2021 Letter INSPECTION SUMMARY
04/27/2021 image.jpg52
04/27/2021 image.jpg53
04/27/2021 Letter INSPECTION SUMMARY
05/19/2021 Letter INSPECTION SUMMARY
06/01/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
06/01/2021 Letter DE-Punch List
07/13/2021 MAINT. BOND - MONTICELLO 4TH PLAT - WATER MAIN
07/13/2021 MAINT. BOND - MONTICELLO 4TH - SS
07/13/2021 MAINT. BOND - MONTICELLO 4TH - ASPHALT & CURBS
07/13/2021 MAINT. BOND - MONTICELLO 4TH - STREETS SUBGRADE
07/13/2021 MAINT. BOND - MONTICELLO 4TH - SANITARY
08/04/2021 image.jpg54
08/04/2021 image.jpg55
08/04/2021 image.jpg56
08/04/2021 Letter INSPECTION SUMMARY
08/20/2021 Monticello 4th Plat Erosion Control Complaints
09/07/2021 Letter INSPECTION SUMMARY
09/14/2021 Water valve at 1200 ne kenwood dr.jpeg
09/14/2021 Water valve at 1200 ne kenwood dr Pic #2.jpeg

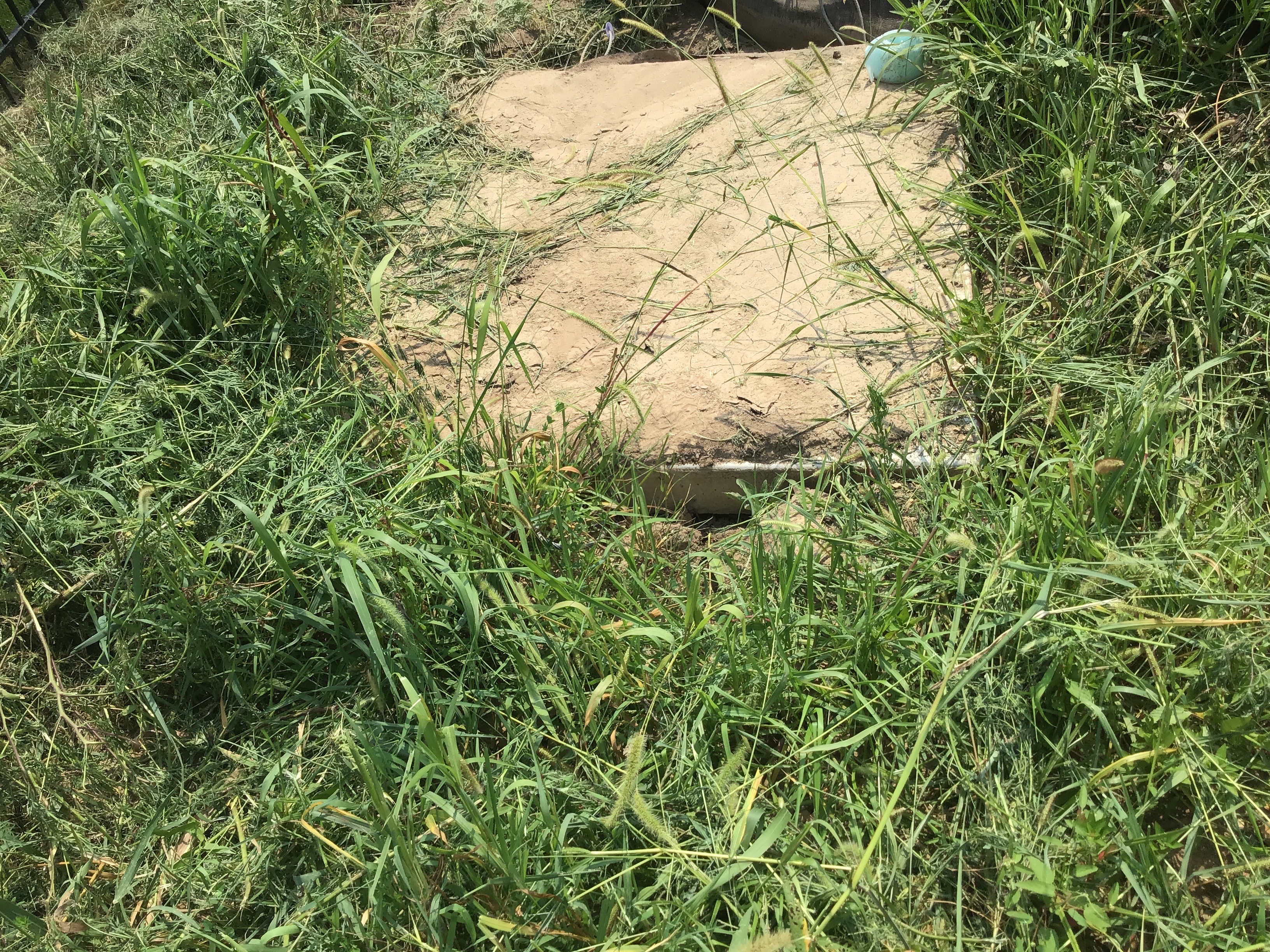

09/14/2021 4712 NE Jamestown Dr Failed sidewalk.jpeg
09/14/2021 Letter INSPECTION SUMMARY
09/17/2021 Letter INSPECTION SUMMARY
10/13/2021 Letter INSPECTION SUMMARY
11/22/2021 Letter INSPECTION SUMMARY
11/22/2021 Letter INSPECTION SUMMARY
03/02/2022 Letter DE-Certificate of Final Acceptance (Commercial)
03/09/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
03/22/2022 Letter INSPECTION SUMMARY
09/12/2022 Monticello 4th Plat Final Affidavit and Agreement
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
