Summary


PRSUBD20192738
Public Infrastructure
Final Acceptance
MAR INVESTMENTS INC
DEVELOPMENT COMPLETE
FULL PLAT DEVELOPMENT - Napa Valley 4th Plat
09/23/2019
08/05/2020
06/01/2024
12/03/2021
Locations
Address
1840 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1836 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1828 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1824 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1816 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1812 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1808 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1841 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1837 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1833 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1829 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1825 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1821 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1817 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1813 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1809 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1805 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Address
1801 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Property
69720061500000000

Property
69720061600000000

Property
69720061700000000

Property
69720061800000000

Property
69720061900000000

Property
69720062000000000

Property
69720062100000000

Property
69720062200000000

Property
69720053500000000

Property
69720053400000000

Property
69720053300000000

Property
69720053200000000

Property
69720053100000000

Property
69720053000000000

Property
69720052900000000

Property
69720052800000000

Property
69720052700000000

Property
69720052600000000

Property
69720052500000000

Address
1800 SW SAGE CANYON RD, LEES SUMMIT, MO 64082

Contacts
MAR INVESTMENTS INC, Address:PO BOX 847
CHOYCE LLC, Address:10712 WILDFLOWER DR
RANDY SPALDING EXCAVATING INC, Address:PO BOX 1421, Phone:(816) 318-9500
LITTMAN LEVI AND KNIPP LACY, Address:1800 SW SAGE CANYON RD
MOORE TIMOTHY & THERESA, Address:1808 SW SAGE CANYON RD
BARBARA R CHESNEY REVOCABLE TRUST DATED 10-13-2011, Address:1812 SW SAGE CANYON RD
BURNAP RICHARD L & TERESA A, Address:1816 SW SAGE CANYON RD
ARMSTRONG CHRISTOPHER THOMAS & AMANDA MAE, Address:1824 SW SAGE CANYON RD
SULLIVAN HENSON E, Address:1828 SW SAGE CANYON RD
KEVIN HIGDON CONSTRUCTION, Address:PO BOX 847, Phone:(816) 524-9797
KEVIN HIGDON CONSTRUCTION LLC, Address:PO BOX 847, Phone:(816) 524-9797
HUBBARD KATHRYN ELAINE, Address:1801 SW SAGE CANYON RD
STEWART CHRISTIAN, Address:1805 SW SAGE CANYON RD
BLAKE CHRISTOPHER J, Address:1809 SW SAGE CANYON RD
WILSON DERECK EUGENE, Address:1813 SW SAGE CANYON RD
HARDING BURTON, Address:1817 SW SAGE CANYON RD
ALLEN SHEA L & LACEY, Address:1825 SW SAGE CANYON RD
VIGNOLA JAY & ELAINE A, Address:1829 SW SAGE CANYON RD
WILSON MITCH AARON & ELIZABETH ANN, Address:1833 SW SAGE CANYON RD
ARNOLD AARON & KATRINA, Address:1837 SW SAGE CANYON RD
THORNE REVOCABLE TRUST LIVING TRUST DATED 08-18-2022, Address:1841 SW SAGE CANYON RD
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 09/23/2019 08/05/2020
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $1,725.17 $1,725.17 Paid Not payable online 09/23/2019
Water Insp Fee $725.51 $725.51 Paid Not payable online 09/23/2019
Storm Sewer Inspection Fee $915.00 $915.00 Paid Not payable online 09/23/2019

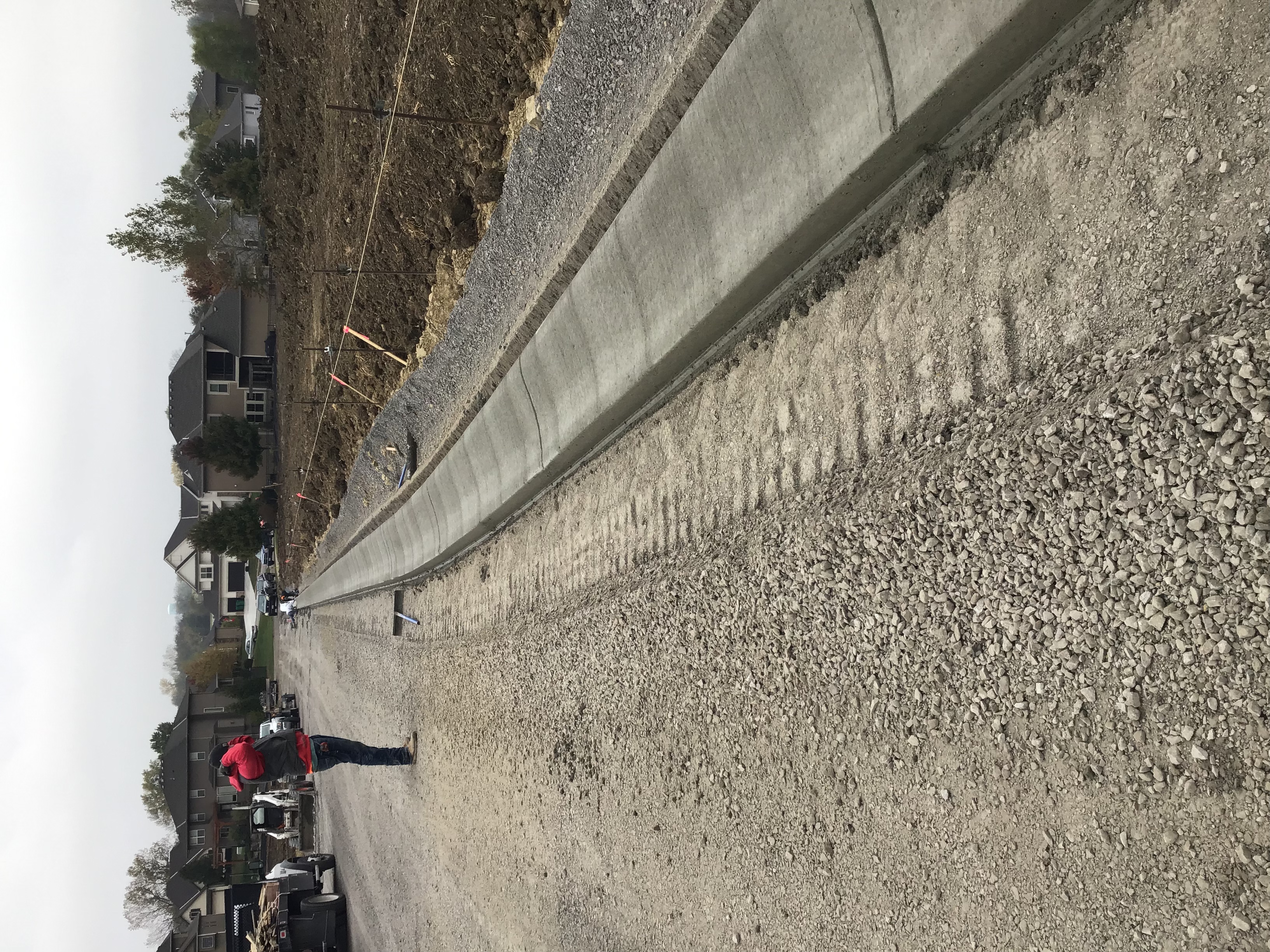

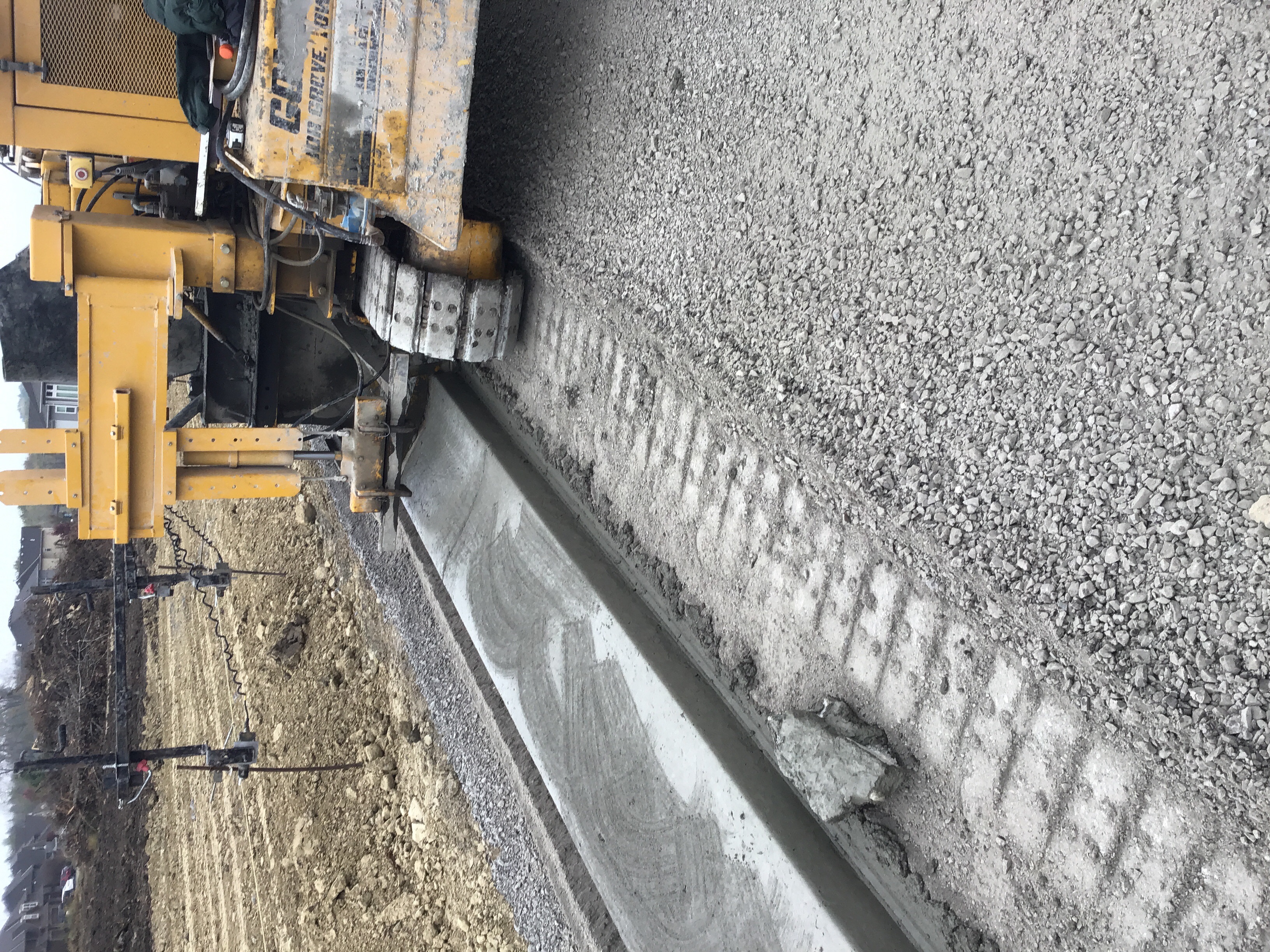

Paved Surface Inspection Fee $3,557.61 $3,557.61 Paid Not payable online 09/23/2019
Site Grading Fee $763.32 $763.32 Paid Not payable online 09/23/2019
Water Test Fee $400.00 $400.00 Paid Not payable online 09/23/2019
Outstanding Fees Amount Paid Owing Date Paid
After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid


$50.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 08/06/2020
Misc
Informational
08/06/2020

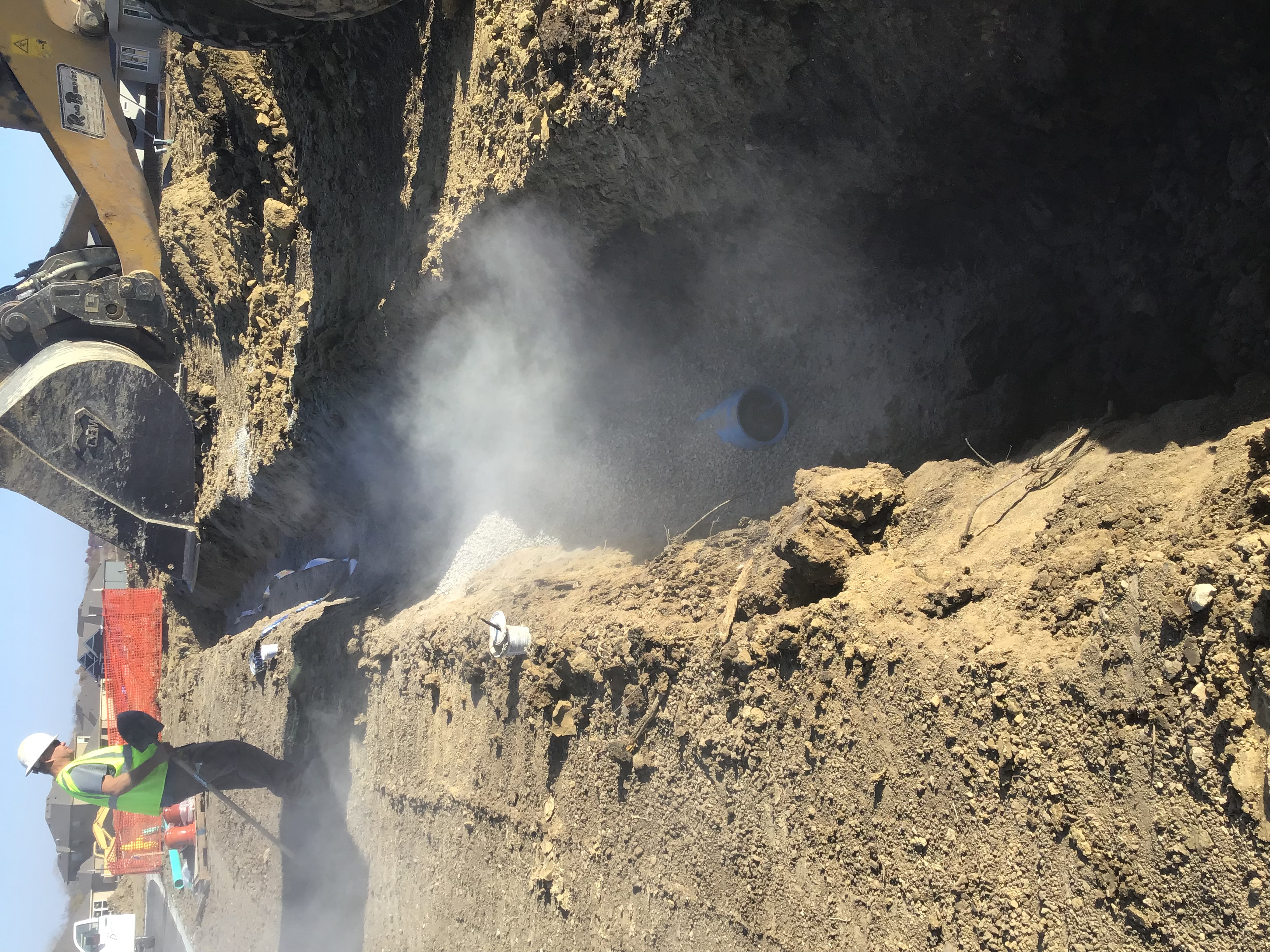

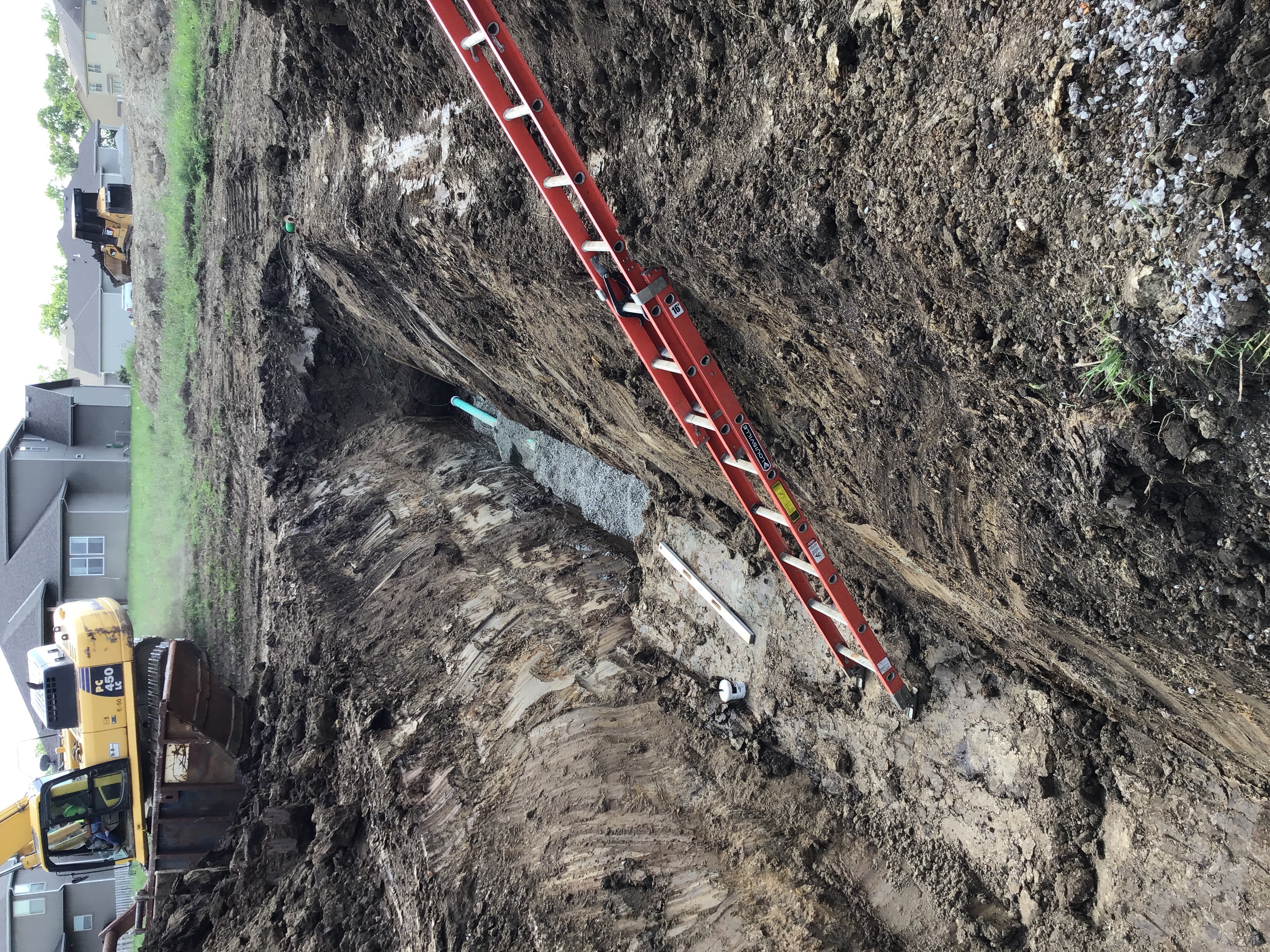

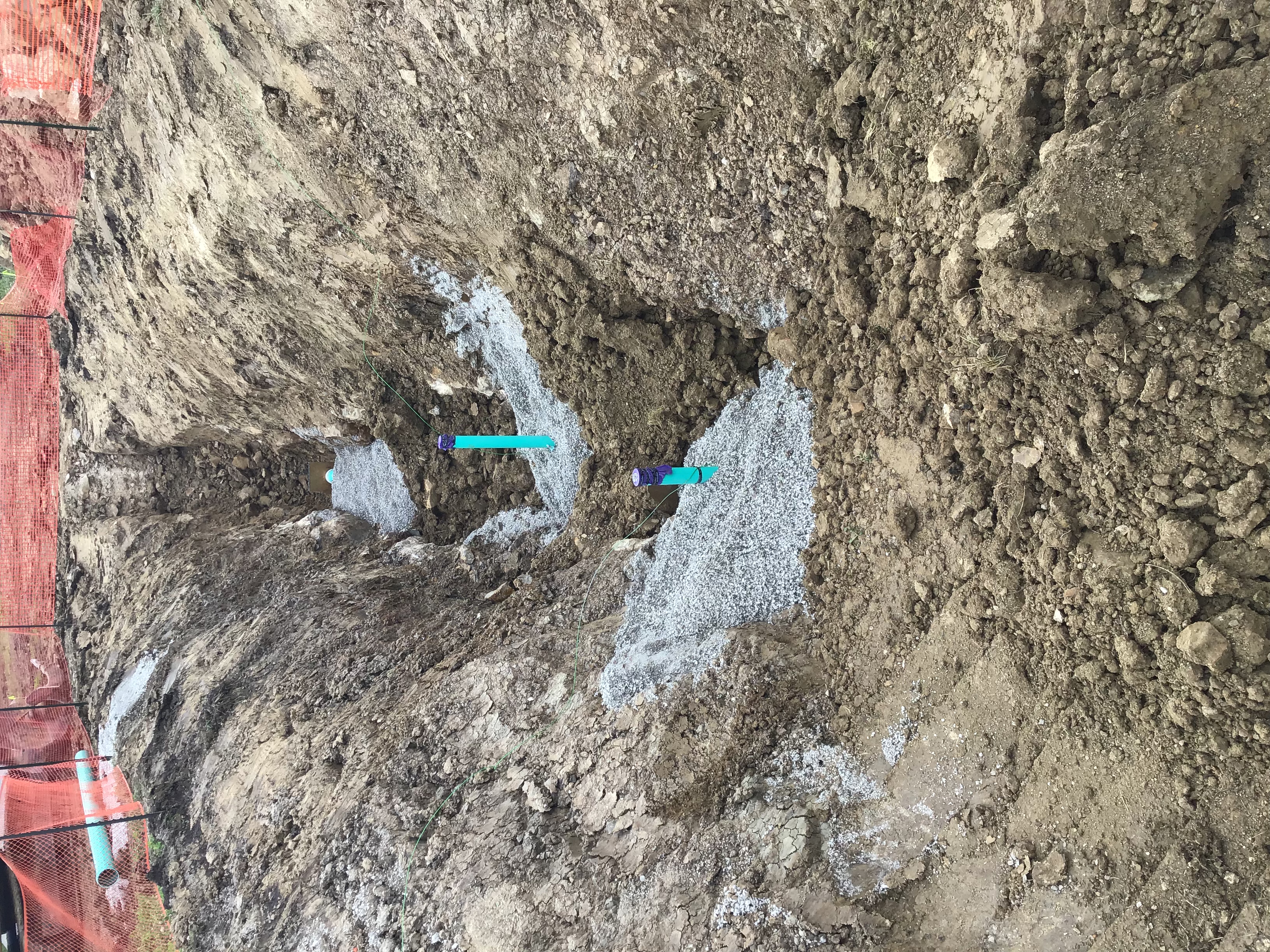

Beamer Construction is on site starting the SS install. The crew exposed existing MH 60-271 and have hit a rock shelf. No pipe has been installed yet due to rock clearing.
Erosion Control Inspection Failed 08/06/2020
Misc
Corrective Action Required
08/06/2020

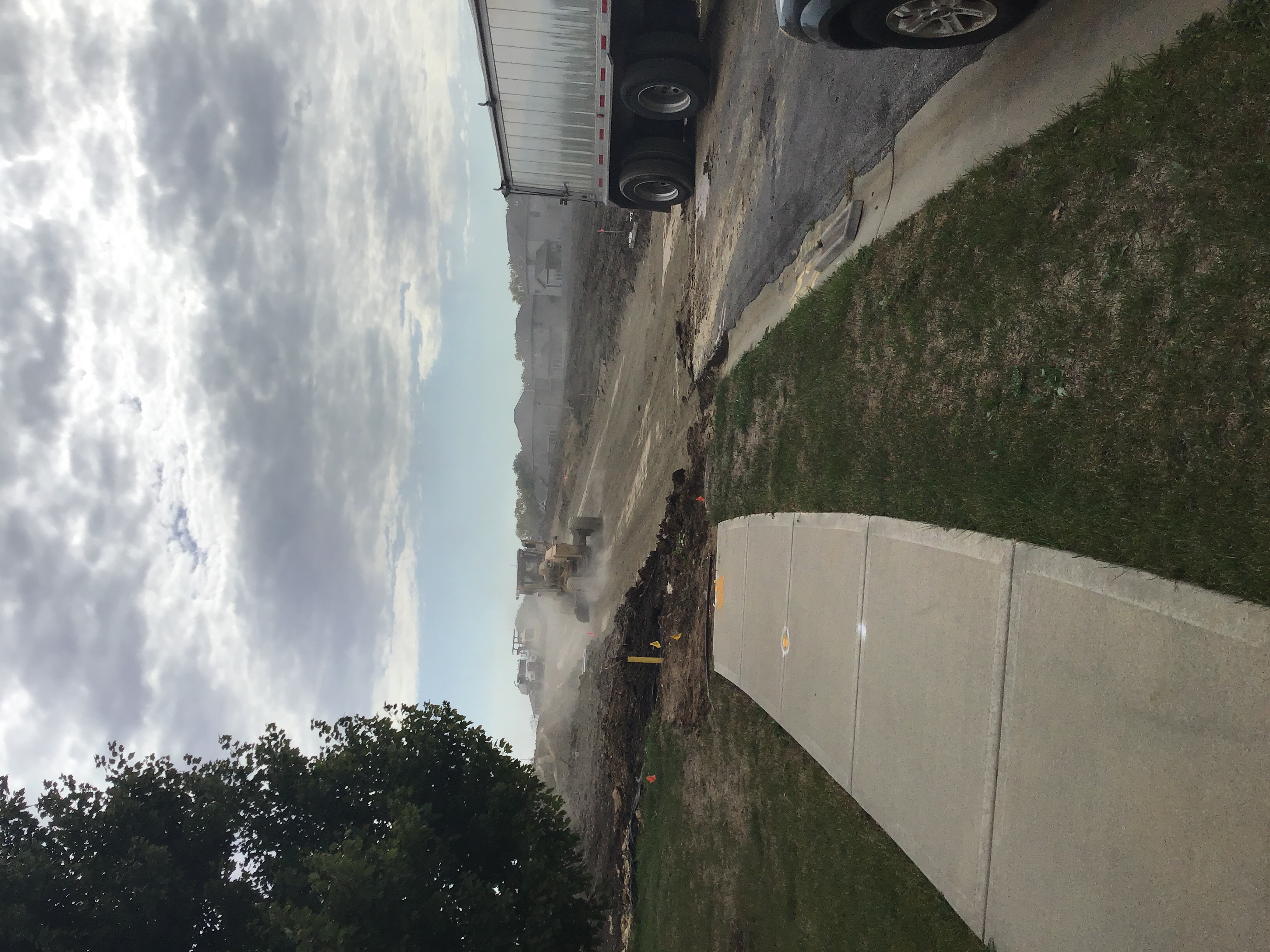

No ESC has been installed yet. Install ESC devices according to the approved plans.
Sanitary Sewer Construction Inspection Partial 08/07/2020
Misc
Informational
08/07/2020

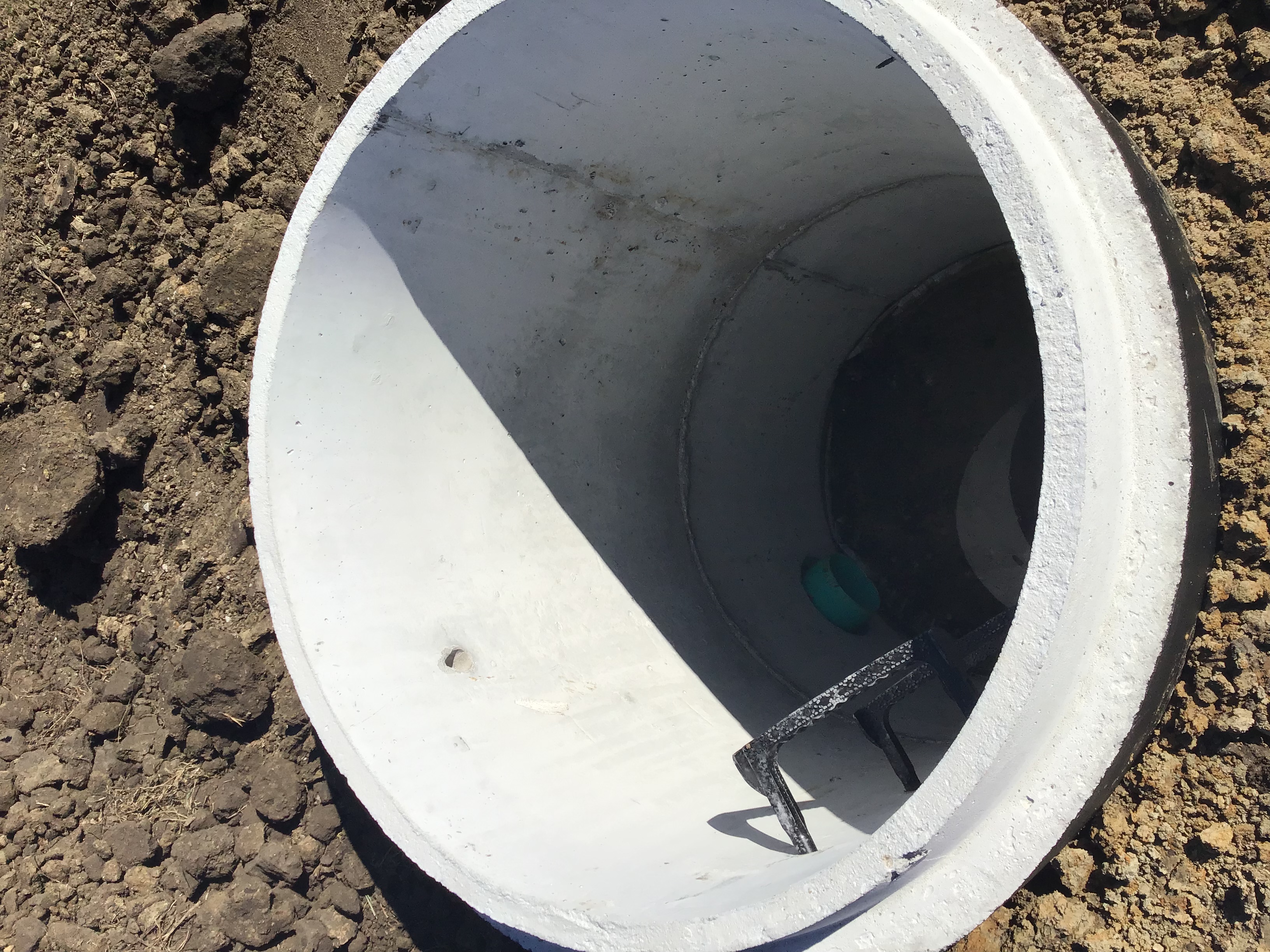

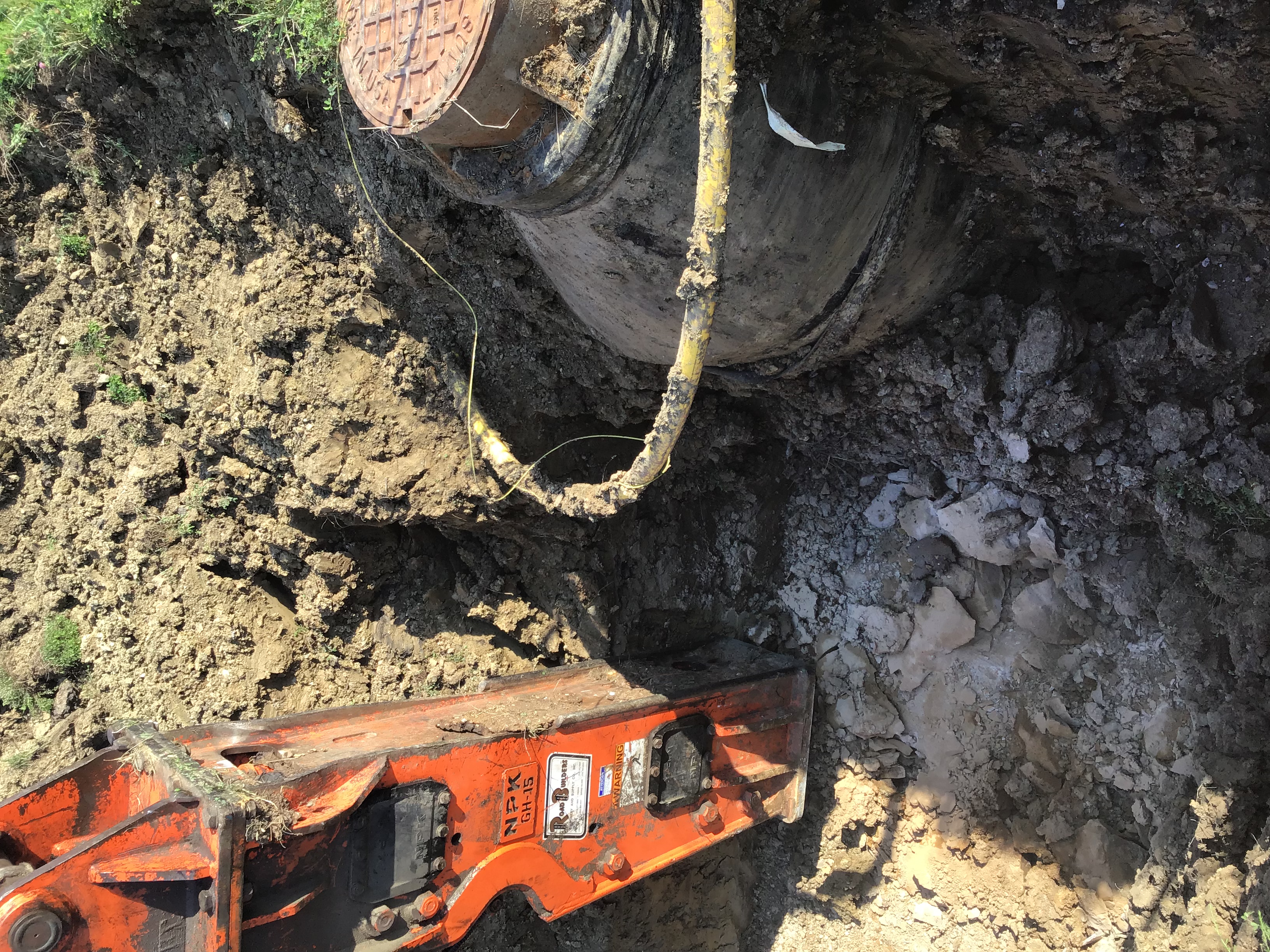

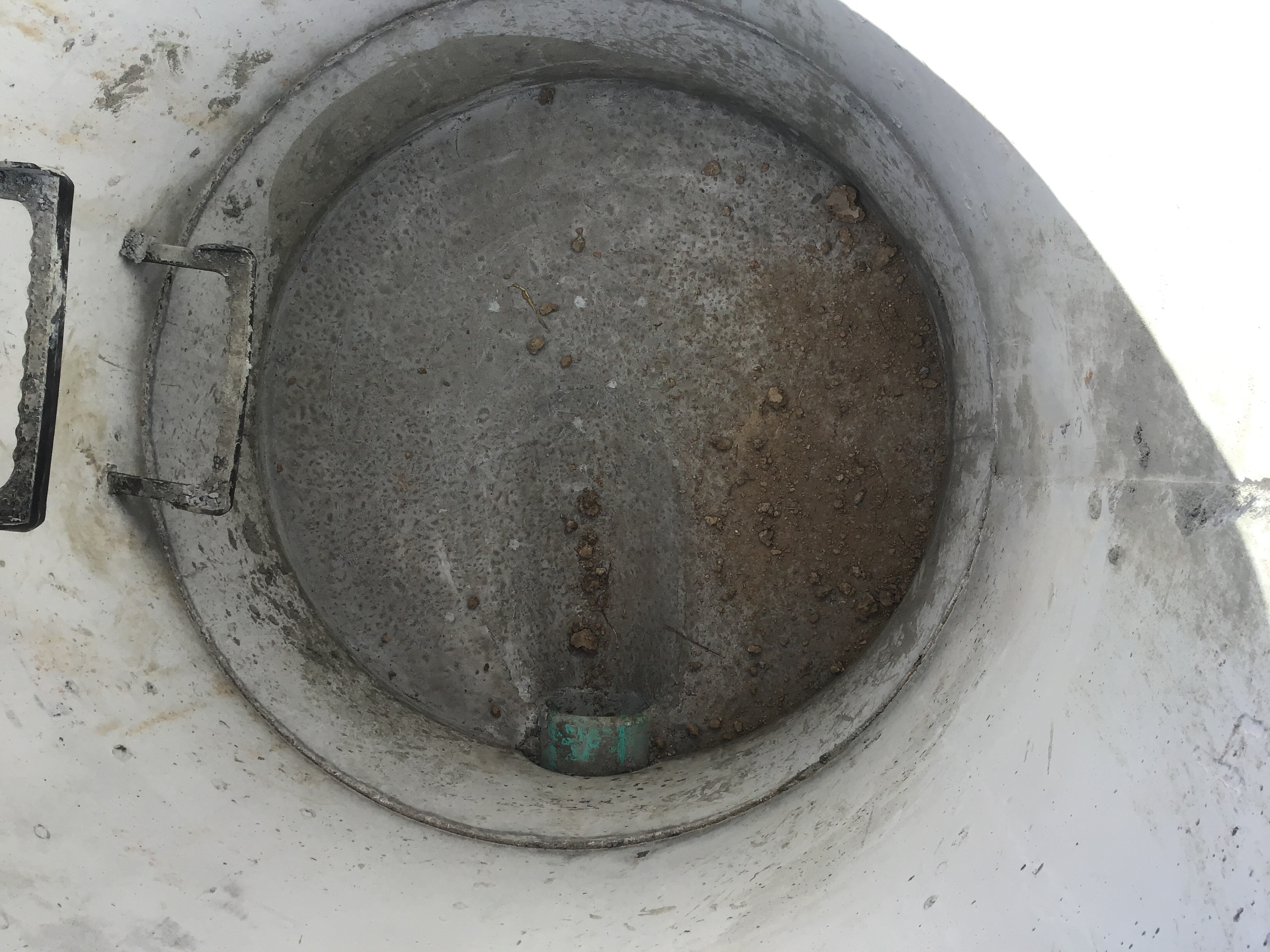

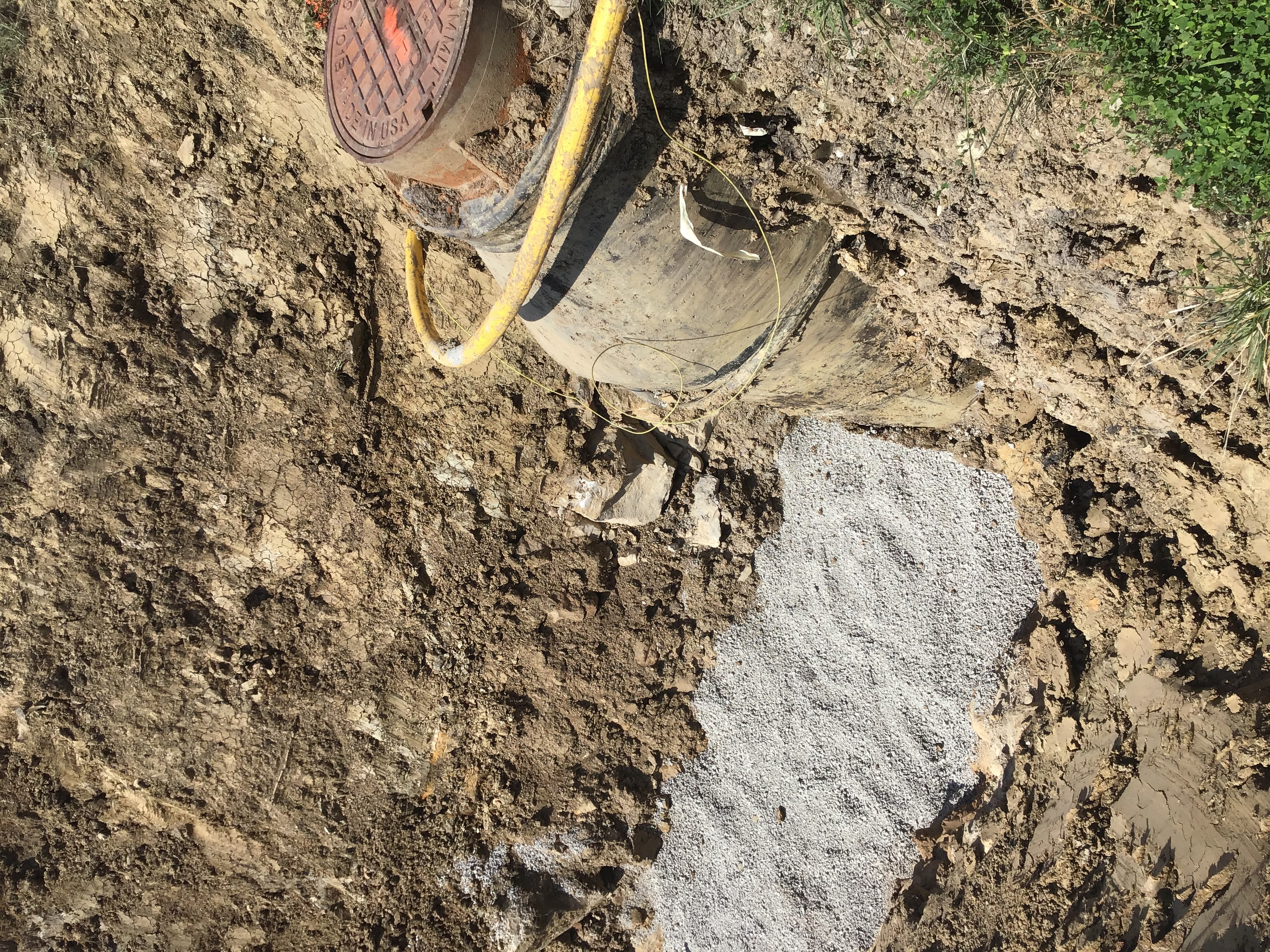

The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Erosion Control Inspection Failed 08/10/2020
Misc
Resolved
08/10/2020
No ESC has been installed yet. Install ESC devices according to the approved plans.
Misc
Corrective Action Required
08/10/2020
FAILED EROSION CONTROL INSPECTION Siltation fence has been installed along the perimeter of the site and is installed according to the approved plans. THE CONSTRUCTION ENTRANCE NEEDS TO BE INSTALLED WITH THE PORPER SIZE AGGREGATE.
Sanitary Sewer Construction Inspection Partial 08/10/2020
Misc
Informational
08/10/2020

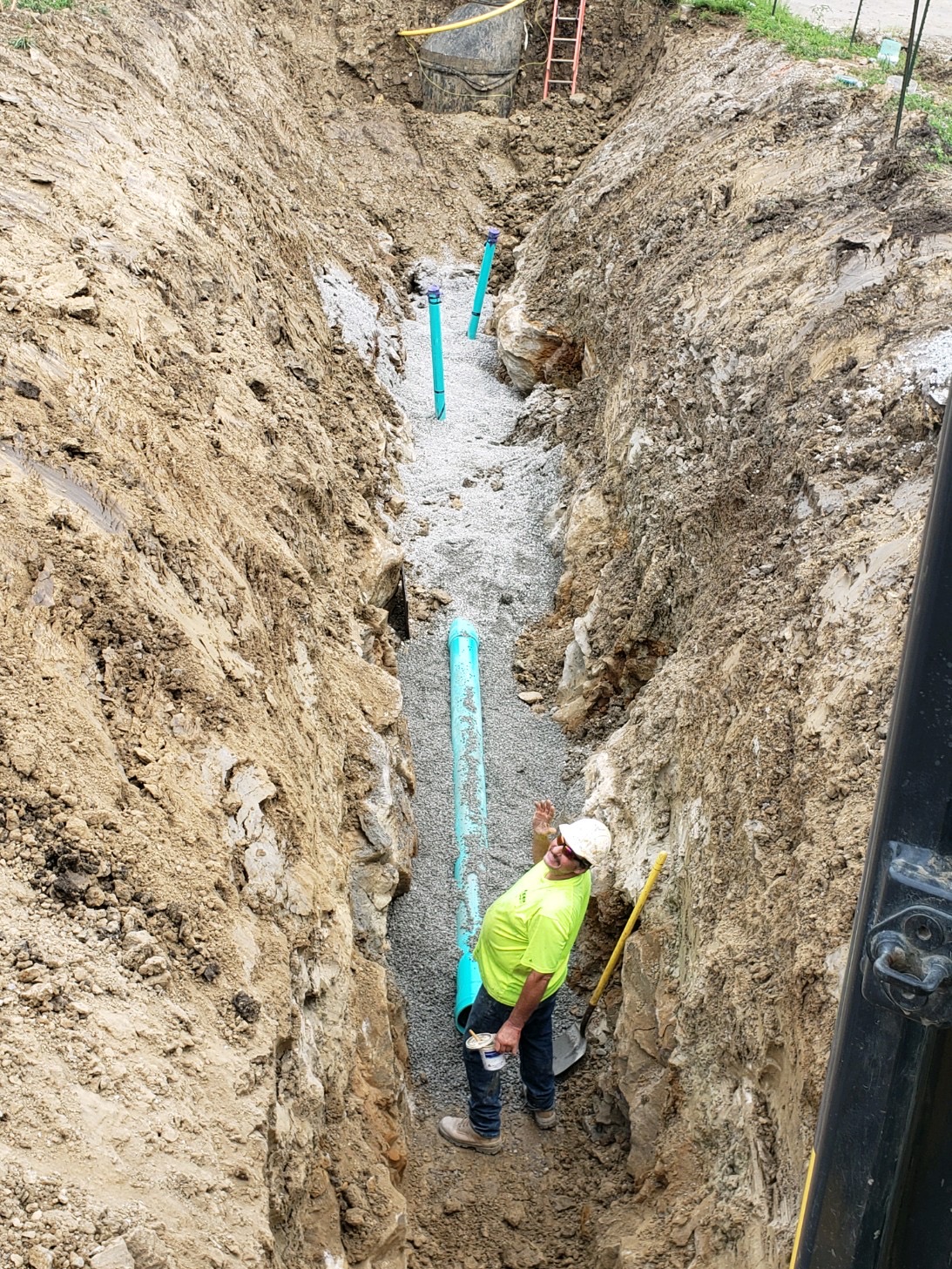

The Beemer construction crew is on site continuing the SS install. The crew is containing to break rock and has not installed any additional pipe at this time. I will return for further inspection this afternoon.
Sanitary Sewer Construction Inspection Partial 08/11/2020
Misc
Informational
08/11/2020
Beemer Construction is on site continuing the SS line A & B install. The crew cored into the existing MH 60-191 and set two sticks of the 8” sewer line on line B. The crew also ran the service line for lot 155. The crew plans to pour the trench check tomorrow. The other crew is continuing the Line A install and has laid approx 50’ ft of the 8”in main. The crew set the Wye’s and vertical risers for lots 154 & 165. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Partial 08/12/2020
Misc
Informational
08/11/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/12/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Partial 08/13/2020
Misc
Informational
08/12/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/12/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/13/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Sanitary Sewer Construction Inspection Partial 08/14/2020
Misc
Informational
08/13/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/13/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/13/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/14/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Erosion Control Inspection Passed 08/17/2020
Misc
Resolved
08/17/2020
FAILED EROSION CONTROL INSPECTION Siltation fence has been installed along the perimeter of the site and is installed according to the approved plans. THE CONSTRUCTION ENTRANCE NEEDS TO BE INSTALLED WITH THE PORPER SIZE AGGREGATE.
Misc
Informational
08/17/2020
The construction entrances are installed. All ESC devices are installed according to the approved plans at this time.
Sanitary Sewer Construction Inspection Partial 08/17/2020
Misc
Informational
08/14/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/14/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/14/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/14/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/17/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Sanitary Sewer Construction Inspection Partial 08/19/2020
Misc
Informational
08/17/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/17/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/17/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/17/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/17/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/19/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Sanitary Sewer Construction Inspection Partial 08/20/2020
Misc
Informational
08/19/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/19/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/19/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/19/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/19/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/19/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Misc
Informational
08/20/2020

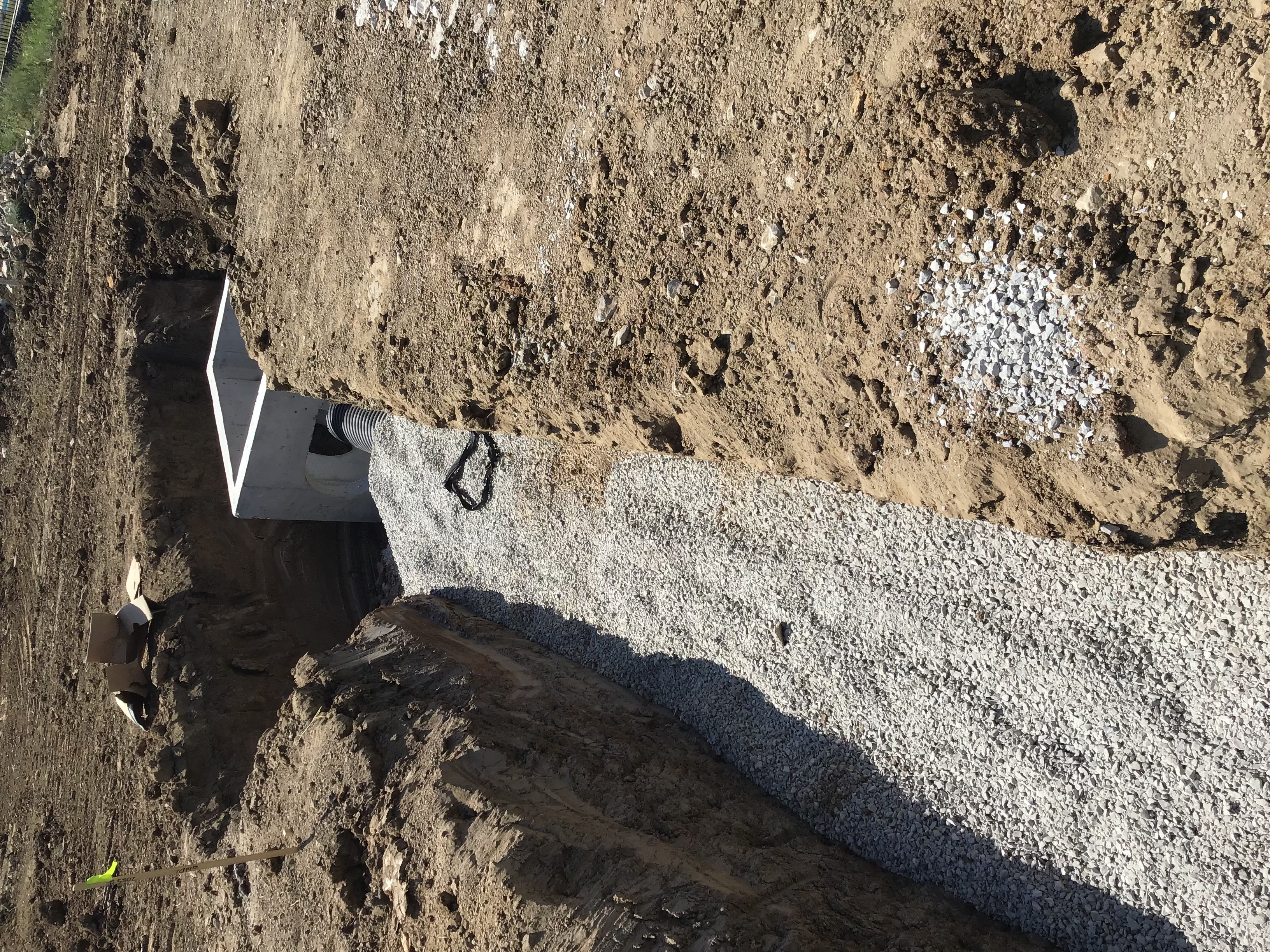

The Beemer crew is continuing the SS line B install. The crew has set the WYE fitting for service to lot 164. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 08/24/2020
Misc
Informational
08/24/2020

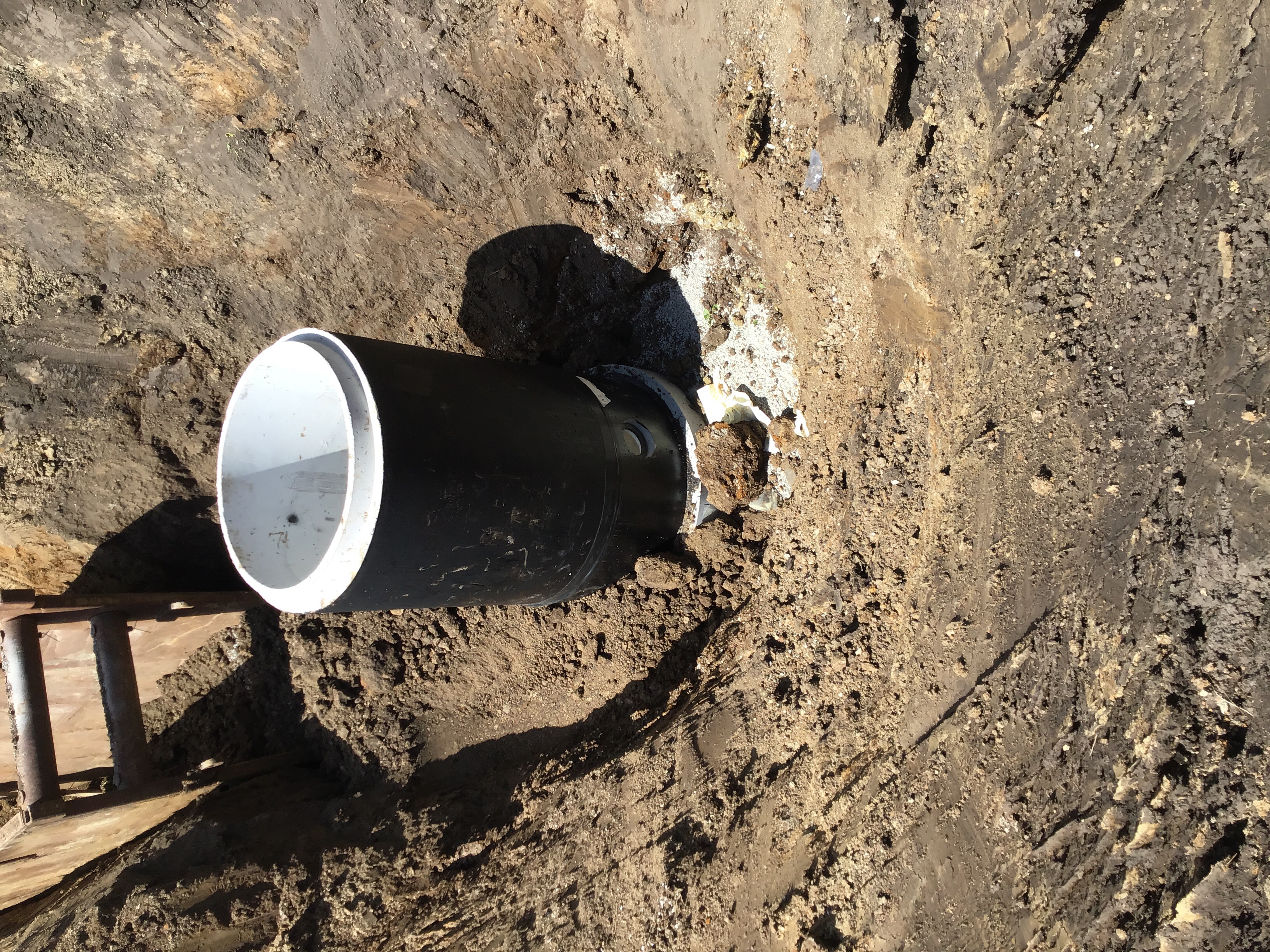

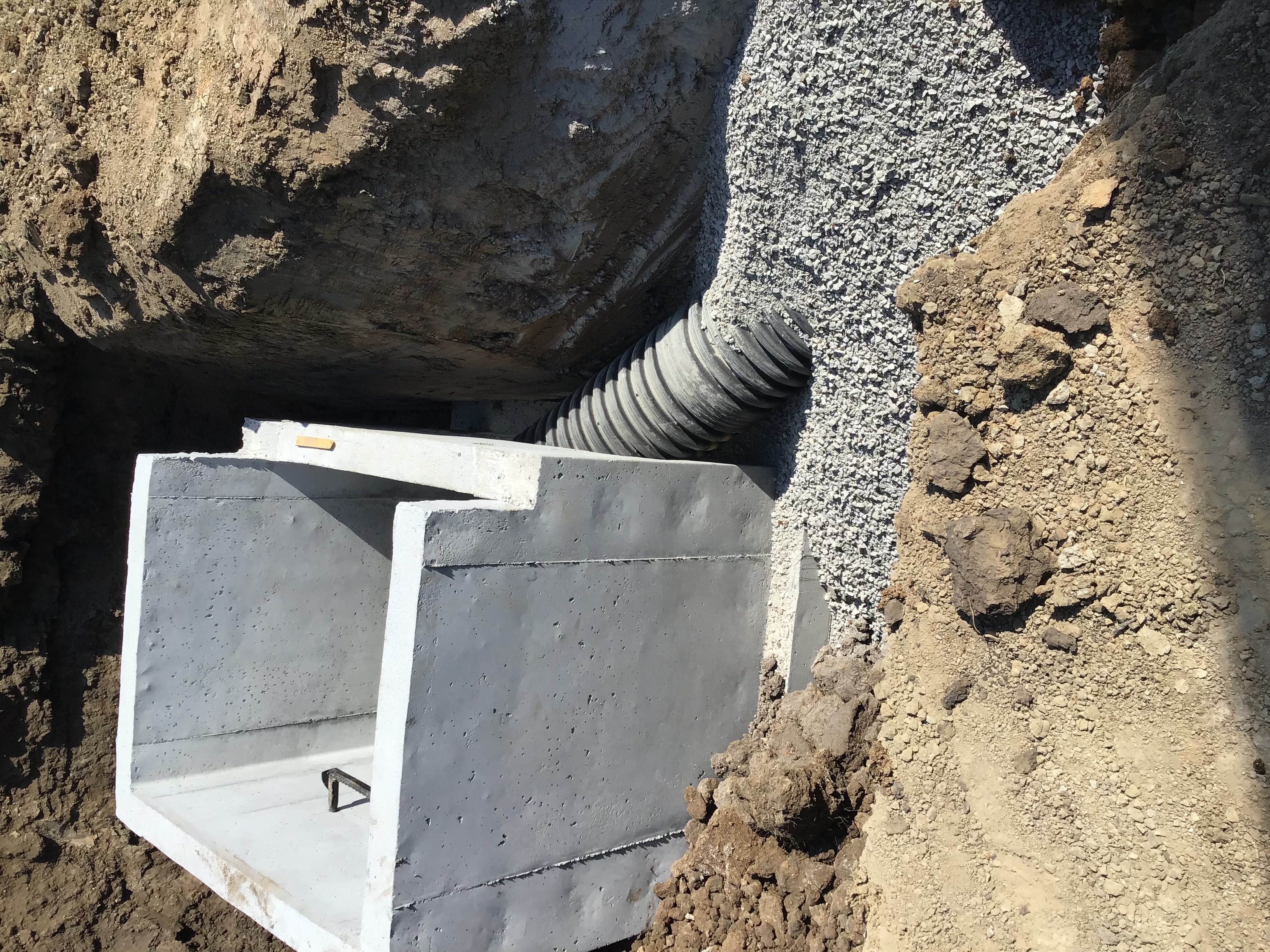

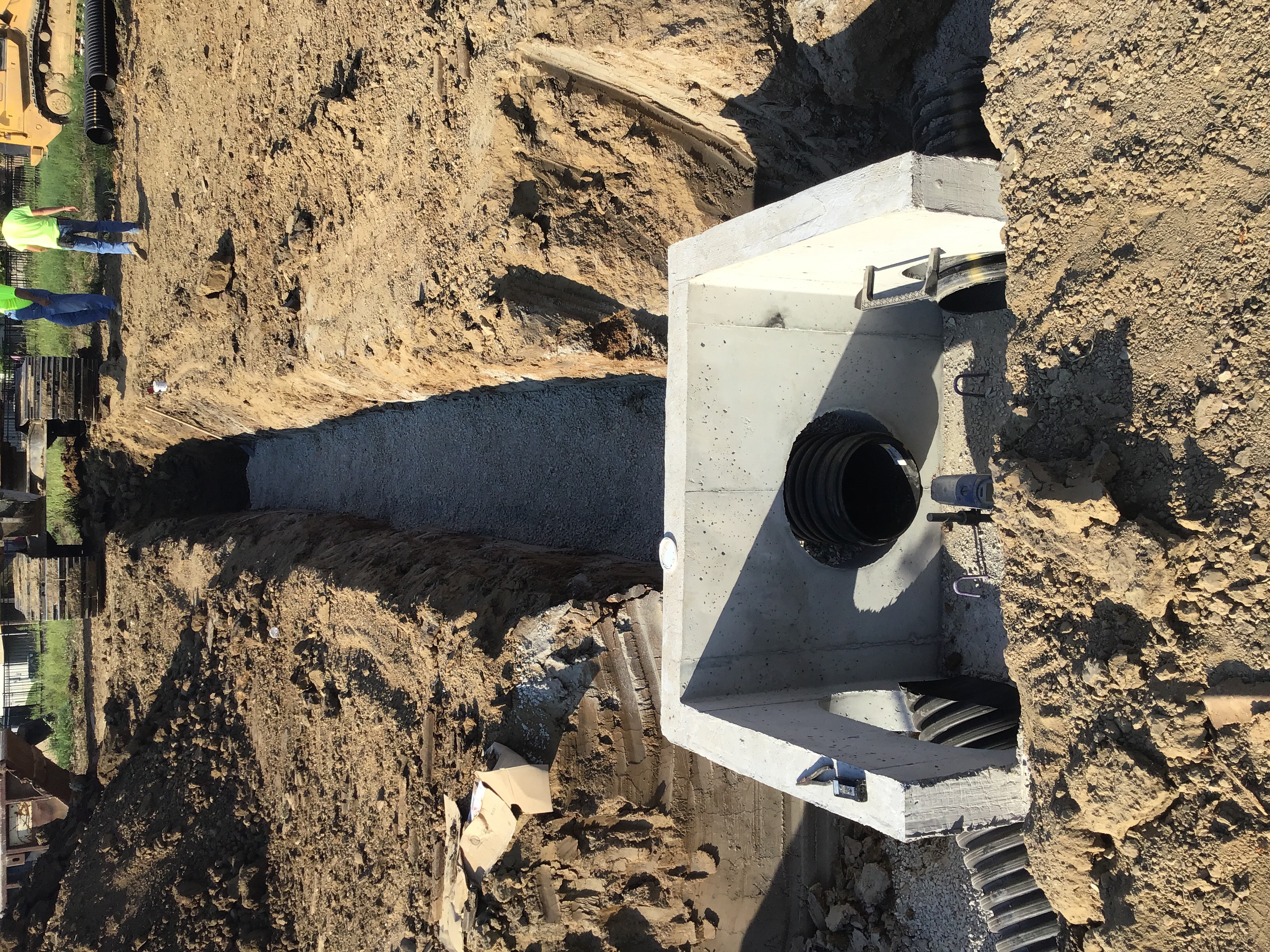

The Beemer crew installed the Storm line 1. The crew tied onto the existing inlet 21-A and installed the 80’ ft of he 15”in HDPE pipe. The crew set both curb inlets 1-1 & 1-2 and ran the pipe between. They plan to pour the collars on Wednesday 8/26/2020. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 08/25/2020
Misc
Informational
08/24/2020
The Beemer crew installed the Storm line 1. The crew tied onto the existing inlet 21-A and installed the 80’ ft of he 15”in HDPE pipe. The crew set both curb inlets 1-1 & 1-2 and ran the pipe between. They plan to pour the collars on Wednesday 8/26/2020. Photos of the work are uploaded.
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 9:33 AM The Beemer crew is working on storm line 2. They have run line 2 from CI 1-1 towards FI 2-1. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Partial 08/25/2020
Misc
Informational
08/20/2020

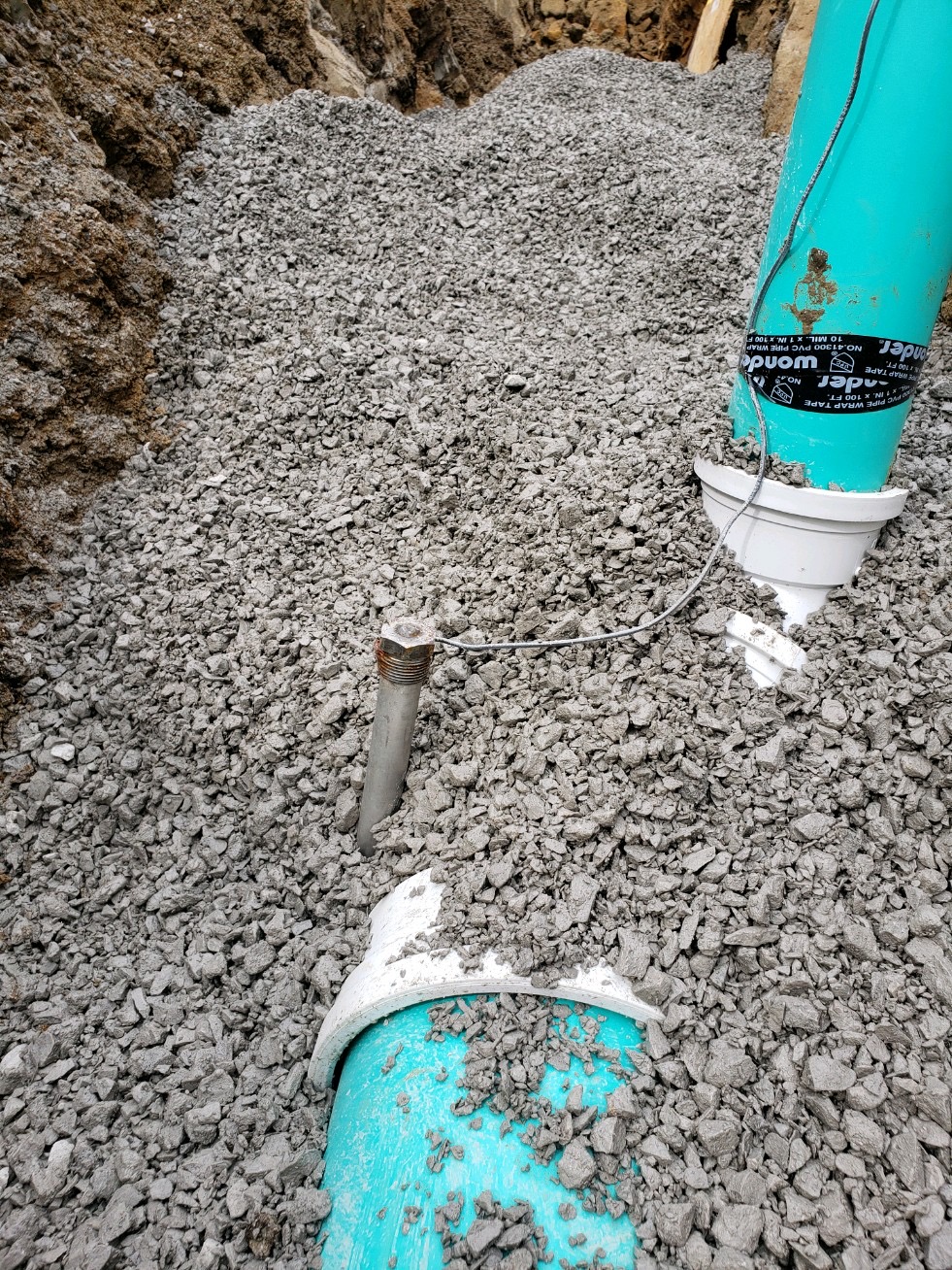

The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/20/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/20/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/20/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/20/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/20/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Misc
Informational
08/20/2020
The Beemer crew is continuing the SS line B install. The crew has set the WYE fitting for service to lot 164. Photos of the work are uploaded.
Misc
Corrective Action Required
08/25/2020

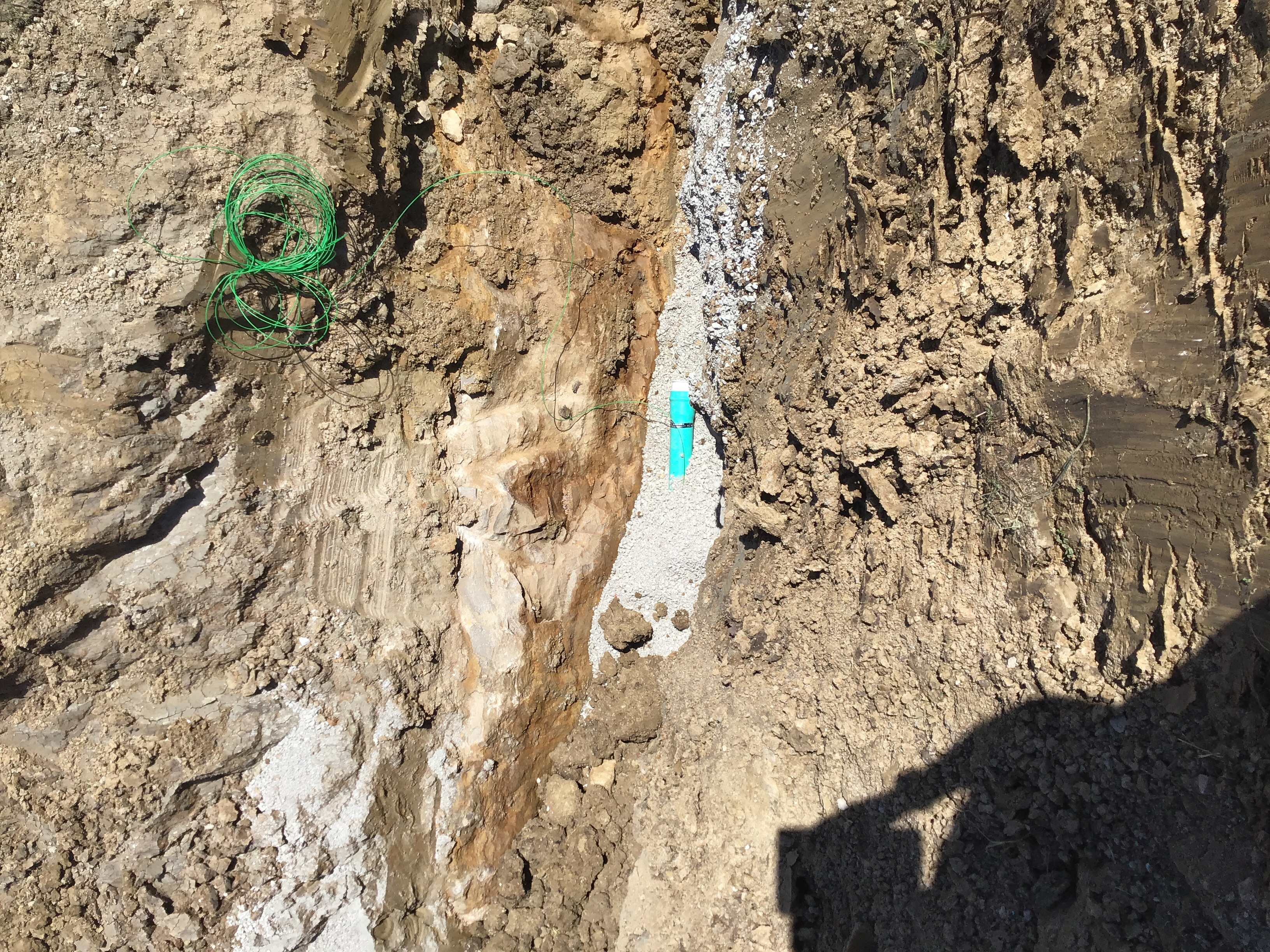

John DiMauro 8/25/2020 9:36 AM KC Testing is on site to run compaction tests for the SS street crossings. I will observe the testing procedure.
Sanitary Sewer Construction Inspection Partial 08/27/2020
Misc
Informational
08/25/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/25/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/25/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/25/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/25/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/25/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Misc
Informational
08/25/2020
The Beemer crew is continuing the SS line B install. The crew has set the WYE fitting for service to lot 164. Photos of the work are uploaded.
Misc
Corrective Action Required
08/25/2020
John DiMauro 8/25/2020 9:36 AM KC Testing is on site to run compaction tests for the SS street crossings. I will observe the testing procedure.
Misc
Informational
08/27/2020

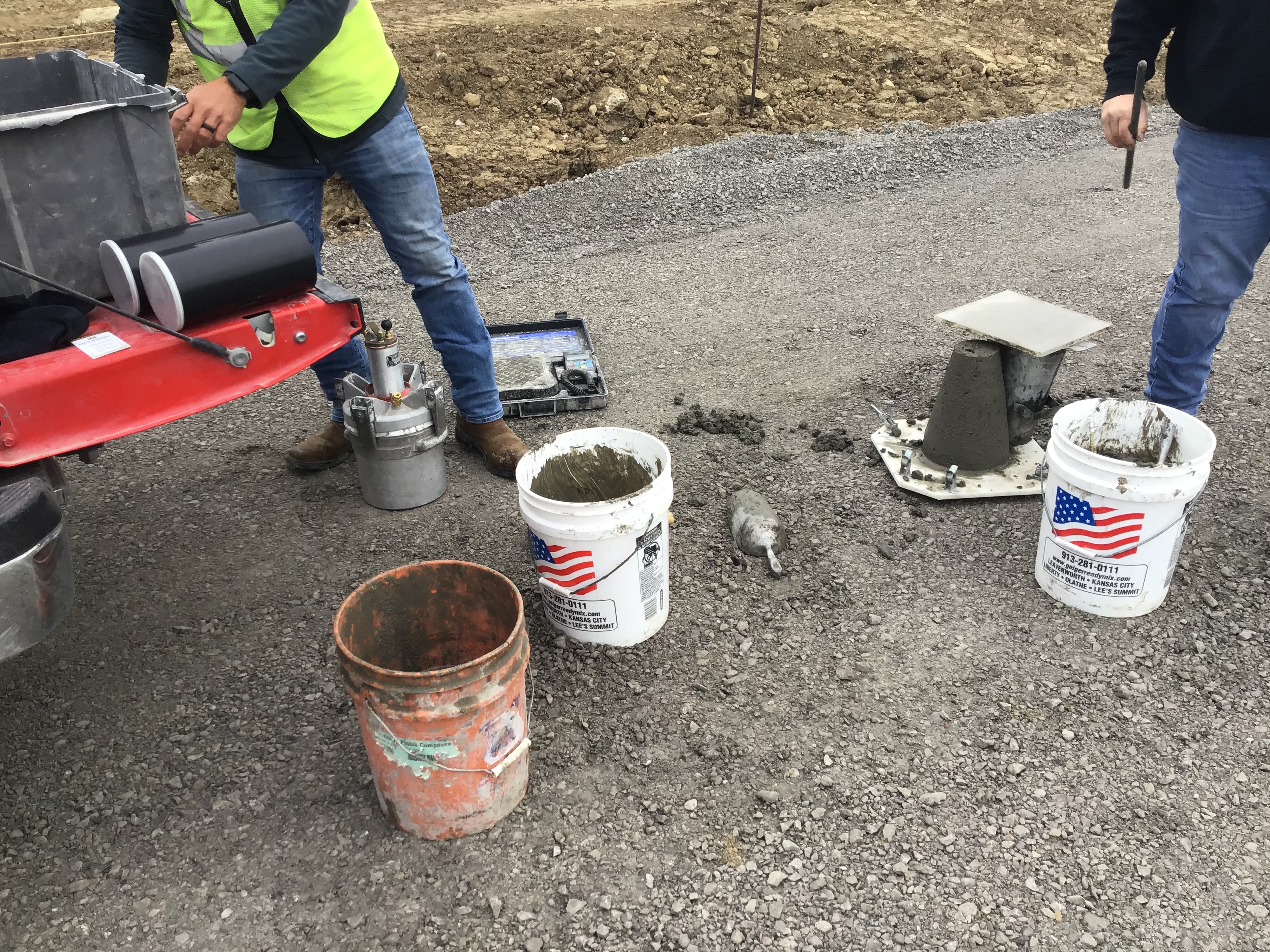

John DiMauro 8/27/2020 10:31 AM The crew poured the inverts for the two SS manholes on site. The crew is currently stacking Manholes A-2 & B-2. Photos of the work have been uploaded.
Sanitary Sewer Construction Inspection Partial 08/28/2020
Misc
Informational
08/27/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/27/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/27/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/27/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/27/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/27/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Misc
Informational
08/27/2020
The Beemer crew is continuing the SS line B install. The crew has set the WYE fitting for service to lot 164. Photos of the work are uploaded.
Misc
Corrective Action Required
08/27/2020
John DiMauro 8/25/2020 9:36 AM KC Testing is on site to run compaction tests for the SS street crossings. I will observe the testing procedure.
Misc
Informational
08/27/2020
John DiMauro 8/27/2020 10:31 AM The crew poured the inverts for the two SS manholes on site. The crew is currently stacking Manholes A-2 & B-2. Photos of the work have been uploaded.
Misc
Informational
08/28/2020
The Beemer Construction Company crew is on site working on SS Line A. The crew is in existing MH 60-191 reconstructing the invert for the new pipe stubbed in. Photos of the work will be uploaded when complete.
Pavement-Stabilized Subgrade Partial 10/02/2020
Misc
Informational
10/02/2020
John DiMauro 10/2/2020 11:30 AM Randy Spalding Excavation crew is on site installing the fly ash sub grade. Photos are uploaded.
Sanitary Sewer - Air Test Passed 10/8/2020 10/8/2020 10/08/2020
Misc
Informational
10/08/2020
John DiMauro 10/8/2020 9:48 AM I observed the air test for SS sewer lines A & B. The results are as follows. Line B: 7:34 min test. Line dropped from 4psi to 3.75psi. Test Passed. Line A: MH A-2 to MH A-1 held at 3.75psi with for 7:34 min with no drop. Test Passed. MH A-1 to Existing MH 60-191 test for 7:34 min. Psi drop from 3.75 to 3.0psi. Test Passed.
Sanitary Sewer - Mandrel Passed 10/8/2020 10/8/2020 10/08/2020
Misc
Informational
10/08/2020
John DiMauro 10/8/2020 11:24 AM I observed the mandrel test for both SS lines A & B. The mandrel pulled through both lines with little deflection. The mandrel got hung up at the the inverts for each of the new manholes but was able to be pulled through with additional effort. The crew plans to grind a little of the excess concrete to allow for a smoother transition from the line to the manholes. Test Passed.
Sanitary Sewer - Vacuum Passed 10/8/2020 10/8/2020 10/08/2020
Misc
Informational
10/08/2020
John DiMauro 10/8/2020 1:26 PM I observed the vacuum tests for the new manholes on SS lines A & B. MH A-1: 10.5’ ft deep. There was a drop from 10” to 9.25” during the 2.5 min test. Test Passed. MH A-2: 10.0’ ft deep. MH held a vacuum of 10” for 2 min with no drop. Test Passed. MH B-1: 10’ ft deep. MH held a vacuum of 10” for 2 min with no drop. Test Passed.
Public Curb Inspection Partial 10/21/2020
Misc
Informational
10/21/2020
John DiMauro 10/21/2020 9:17 AM Turner & Michael Concrete is on site installing the public curb sections. Geiger Ready Mix is on site performing the concrete testing, they will provide me with the reports. I verified the correct concrete mix and methods used for the install. Photos of the work are uploaded.
Pavement-Proof Roll Passed 11/02/2020
Misc
Informational
11/02/2020
John DiMauro 11/02/2020 I observed the proof roll of the base rock this morning and verified the correct load weight. The roll test passed no deflection.
Pavement-Aggregate Base Partial 11/03/2020
Misc
Informational
11/03/2020
John DiMauro 11/03/2020 10:17 AM Tandem Paving is on site currently installing the base asphalt lift for the public road. I am verifying the correct mix type and temperature of the asphalt. Photos will be uploaded.
Pavement-Aggregate Base Passed 11/03/2020
Misc
Informational
11/03/2020
John DiMauro 11/03/2020 10:17 AM Tandem Paving is on site currently installing the base asphalt lift for the public road. I am verifying the correct mix type and temperature of the asphalt. Photos will be uploaded.
Misc
Informational
11/03/2020
John DiMauro 11/03/2020 1:00 PM Overtime / Lunch Inspection 12PM - 1PM The Base asphalt lift for the road has been installed at this time. I verified the correct mix type and temperature as well as the methods used for the install were in compliance. The crew plans to let the base lift cool down and try to install the surface lift today.
Pavement-Surface Partial 11/03/2020
Misc
Informational
11/03/2020
John DiMauro 11/02/2020 3:07 PM The Tandem Paving crew is installing the surface lift for the roads. I verified the correct mix type, temperature and methods used for the install.
Water Line - Construction Inspection Partial 11/03/2020
Misc
Informational
11/03/2020
John DiMauro 11/03/2020 3:30 PM The Beemer crew started the water line install. The crew started on the east end at station 7+78.49 and installed approximately 2 sticks of the 8” main. There is a conflict with clearance between the new water line and the existing storm line. The crew finished for the day and will resume tomorrow once a solution to the conflicting lines has been determined. Photos are uploaded.
Pavement-Surface Passed 11/03/2020
Misc
Informational
11/03/2020
John DiMauro 11/02/2020 3:07 PM The Tandem Paving crew is installing the surface lift for the roads. I verified the correct mix type, temperature and methods used for the install.
Misc
Informational
11/03/2020
John DiMauro 11/03/2020 After hours inspection / OT. 4:30 PM - 5:00 PM The Tandem Paving crew completed the surface lift install. The install is in compliance at this time.
Erosion Control Inspection Failed 11/04/2020
Misc
Informational
11/04/2020
John DiMauro 11/04/2020 9:22 AM The erosion control devices need on site need to be corrected and maintained. Make corrections asap. Photos are uploaded.
Water Line - Construction Inspection Partial 11/04/2020
Misc
Informational
11/04/2020
John DiMauro 11/04/2020 3:12 PM The Beemer crew has the water line installed from 7+78.49 to approx 5+00. The line crosses under the existing storm at approx station 7+65 with insufficient clearance. The crew plans to encase the water line on Friday 11/06/20. Photos are uploaded.
Water Line - Construction Inspection Partial 11/05/2020
Misc
Informational
11/04/2020
John DiMauro 11/04/2020 3:12 PM The Beemer crew has the water line installed from 7+78.49 to approx 5+00. The line crosses under the existing storm at approx station 7+65 with insufficient clearance. The crew plans to encase the water line on Friday 11/06/20. Photos are uploaded.
Misc
Informational
11/05/2020
John DiMauro 11/05/2020 3:00 PM The Beemer crew has the water line installed to approx station 4+00. The crew installed the hydrant assembly at station 4+79.11 Photos are uploaded.
Water Line - Hydrostatic Test Passed 11/09/2020
Misc
Informational
11/09/2020
John DiMauro 11/09/2020 3:07 PM I observed the hydrostatic pressure test for the water line. The line held at 160 PSI for 2 hours with no drop.
Water Line - Construction Inspection Partial 11/09/2020
Misc
Informational
11/05/2020
John DiMauro 11/04/2020 3:12 PM The Beemer crew has the water line installed from 7+78.49 to approx 5+00. The line crosses under the existing storm at approx station 7+65 with insufficient clearance. The crew plans to encase the water line on Friday 11/06/20. Photos are uploaded.
Misc
Informational
11/05/2020
John DiMauro 11/05/2020 3:00 PM The Beemer crew has the water line installed to approx station 4+00. The crew installed the hydrant assembly at station 4+79.11 Photos are uploaded.
Misc
Informational
11/06/2020
John DiMauro 11/06/2020 3:50 PM The Beemer crew installed the water line up from approx station 1+00 to 8+00. The crew installed the two hydrant assembly’s and poured the kickers for them. Photos are uploaded.
Misc
Informational
11/09/2020
John DiMauro 11/09/2020 3:11 PM The water line is installed up to the west tie in point. The hydro test passed today and the crew is preparing to inject chlorine into the line. I verified the correct chlorine amount tag the test points. The crew will flush tomorrow and pull a bacteria sample on Wednesday 11/11.
Water Line - Construction Inspection Partial 11/17/2020
Misc
Informational
11/09/2020
John DiMauro 11/04/2020 3:12 PM The Beemer crew has the water line installed from 7+78.49 to approx 5+00. The line crosses under the existing storm at approx station 7+65 with insufficient clearance. The crew plans to encase the water line on Friday 11/06/20. Photos are uploaded.
Misc
Informational
11/09/2020
John DiMauro 11/05/2020 3:00 PM The Beemer crew has the water line installed to approx station 4+00. The crew installed the hydrant assembly at station 4+79.11 Photos are uploaded.
Misc
Informational
11/09/2020
John DiMauro 11/06/2020 3:50 PM The Beemer crew installed the water line up from approx station 1+00 to 8+00. The crew installed the two hydrant assembly’s and poured the kickers for them. Photos are uploaded.
Misc
Informational
11/09/2020
John DiMauro 11/09/2020 3:11 PM The water line is installed up to the west tie in point. The hydro test passed today and the crew is preparing to inject chlorine into the line. I verified the correct chlorine amount tag the test points. The crew will flush tomorrow and pull a bacteria sample on Wednesday 11/11.
Misc
Informational
11/17/2020
John DiMauro 11/17/2020 1:58 PM The Beemer crew completed the west tie in today. The water line is now in service. Photos are uploaded.
Erosion Control Inspection Failed 11/30/2020
Misc
Informational
11/04/2020
John DiMauro 11/04/2020 9:22 AM The erosion control devices need on site need to be corrected and maintained. Make corrections asap. Photos are uploaded.
Misc
Corrective Action Required
11/30/2020
John DiMauro 11/30/2020 8:54am The ESC devices on site need to be corrected and maintained. Additionally, the inlets need protection installed.
Erosion Control Inspection Failed 01/25/2021
Misc
Resolved
01/25/2021
John DiMauro 11/04/2020 9:22 AM The erosion control devices need on site need to be corrected and maintained. Make corrections asap. Photos are uploaded.
Misc
Resolved
01/25/2021
John DiMauro 11/30/2020 8:54am The ESC devices on site need to be corrected and maintained. Additionally, the inlets need protection installed.
Misc
Corrective Action Required
01/25/2021
John DiMauro 1/25/2021 Erosion control devices need to be maintained for this project. Gutter protection needs cleaned and silt fence needs to be restored at perimeter and low lying areas to control silt runoff. The 3 area inlets along the south side of the project need to be protected with inlet devices asap. Mud and silt is running into the storm water collection system.
Install Street and Stop Signs Passed 12/03/2021
Storm Sewer Construction Inspection Passed 12/03/2021
Misc
Informational
08/25/2020
The Beemer crew installed the Storm line 1. The crew tied onto the existing inlet 21-A and installed the 80’ ft of he 15”in HDPE pipe. The crew set both curb inlets 1-1 & 1-2 and ran the pipe between. They plan to pour the collars on Wednesday 8/26/2020. Photos of the work are uploaded.
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 9:33 AM The Beemer crew is working on storm line 2. They have run line 2 from CI 1-1 towards FI 2-1. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Passed 12/03/2021
Misc
Informational
08/28/2020
The crew core drilled into existing MH 60-182 and installed a section of the 8” Line B pipe. Photos are uploaded.
Misc
Informational
08/28/2020
John DiMauro 8/12/2020 3:02 PM The Beemer crew is on site continuing the SS install. Crews are working on both A & B lines. They have run into some rock that has slowed the install down. The crew on the west side has set MH A-1 and Ran the pipe to it. Service lines for lots 147 & 155 are installed at this time. The crew on the east has approx 40’ft of the the B line run and is working on service for lot 165. Photos of the work are uploaded.
Misc
Informational
08/28/2020
John DiMauro 8/13/2020 10:40 AM The crews are working on both east and west sides of the site. Progress is slow moving with the amount of rock being excavated. I will return after lunch for further inspection.
Misc
Informational
08/28/2020
The Beemer crew is continuing the SS install. The crew on the west end has the line ran to approx 2+28. The crew set MH A-1. Service line for lot 157 is installed at this time.
Misc
Informational
08/28/2020
John DiMauro 8/17/2020 10:40 am The crew is continuing the install of sanitary lines A & B. Crews were digging and breaking rock while I was on site. I will return for further inspection this afternoon.
Misc
Informational
08/28/2020
John DiMauro 8/19/2020 10:15 AM The crew on the west end of the site completed the SS Line A install. The crew set MH A-2 today. The inverts still need to be poured but the pipe install is complete, this includes lots 147 - 150 & 155 - 160. The crew on the east end continues to break rock for the proper trench size.
Misc
Informational
08/28/2020
The Beemer crew is continuing the SS line B install. The crew has set the WYE fitting for service to lot 164. Photos of the work are uploaded.
Misc
Corrective Action Required
08/28/2020
John DiMauro 8/25/2020 9:36 AM KC Testing is on site to run compaction tests for the SS street crossings. I will observe the testing procedure.
Misc
Informational
08/28/2020
John DiMauro 8/27/2020 10:31 AM The crew poured the inverts for the two SS manholes on site. The crew is currently stacking Manholes A-2 & B-2. Photos of the work have been uploaded.
Misc
Informational
08/28/2020
The Beemer Construction Company crew is on site working on SS Line A. The crew is in existing MH 60-191 reconstructing the invert for the new pipe stubbed in. Photos of the work will be uploaded when complete.
Pavement-Stabilized Subgrade Passed 12/03/2021
Misc
Informational
10/02/2020
John DiMauro 10/2/2020 11:30 AM Randy Spalding Excavation crew is on site installing the fly ash sub grade. Photos are uploaded.
Sanitary Sewer - Camera Test Passed 10/8/2020 10/8/2020 12/03/2021
Public Curb Inspection Passed 12/03/2021
Misc
Informational
10/21/2020
John DiMauro 10/21/2020 9:17 AM Turner & Michael Concrete is on site installing the public curb sections. Geiger Ready Mix is on site performing the concrete testing, they will provide me with the reports. I verified the correct concrete mix and methods used for the install. Photos of the work are uploaded.
Water Line - Coliform Test 1 Passed 12/03/2021
Water Line - Construction Inspection Passed 12/03/2021
Misc
Informational
11/17/2020
John DiMauro 11/04/2020 3:12 PM The Beemer crew has the water line installed from 7+78.49 to approx 5+00. The line crosses under the existing storm at approx station 7+65 with insufficient clearance. The crew plans to encase the water line on Friday 11/06/20. Photos are uploaded.
Misc
Informational
11/17/2020
John DiMauro 11/05/2020 3:00 PM The Beemer crew has the water line installed to approx station 4+00. The crew installed the hydrant assembly at station 4+79.11 Photos are uploaded.
Misc
Informational
11/17/2020
John DiMauro 11/06/2020 3:50 PM The Beemer crew installed the water line up from approx station 1+00 to 8+00. The crew installed the two hydrant assembly’s and poured the kickers for them. Photos are uploaded.
Misc
Informational
11/17/2020
John DiMauro 11/09/2020 3:11 PM The water line is installed up to the west tie in point. The hydro test passed today and the crew is preparing to inject chlorine into the line. I verified the correct chlorine amount tag the test points. The crew will flush tomorrow and pull a bacteria sample on Wednesday 11/11.
Misc
Informational
11/17/2020
John DiMauro 11/17/2020 1:58 PM The Beemer crew completed the west tie in today. The water line is now in service. Photos are uploaded.
Record Drawing Review Passed 2/11/2021 12/03/2021
Erosion Control Inspection Passed 12/03/2021
Misc
Corrective Action Required
01/25/2021
John DiMauro 1/25/2021 Erosion control devices need to be maintained for this project. Gutter protection needs cleaned and silt fence needs to be restored at perimeter and low lying areas to control silt runoff. The 3 area inlets along the south side of the project need to be protected with inlet devices asap. Mud and silt is running into the storm water collection system.
Sanitary Sewer - Air Test Passed 12/03/2021
Sanitary Sewer - Vacuum Passed 12/03/2021
Sanitary Sewer - Camera Test Passed 1/3/2022 12/03/2021
Water Line - Coliform Test 2 Passed 12/03/2021
Water Line - Hydrostatic Test Passed 12/03/2021
Water Line - Coliform Test 1 Passed 12/03/2021
Sanitary Sewer - Mandrel Passed 12/03/2021
Water Line - Coliform Test 2 Passed 12/03/2021
Storm - Swales Passed 12/03/2021
ESC - (Vegetation/Ground Cover) Passed 12/03/2021
Install Street and Stop Signs Passed 12/03/2021
Documents & Images
Date Uploaded File Type Document Name
09/23/2019 Receipt Receipt for transaction: 2019-006384
11/06/2019 Receipt Receipt for transaction: 2019-006384
08/05/2020 Letter DE-Permit
08/05/2020 Water Complete Set
08/05/2020 Sanitary Complete Set
08/05/2020 Street & Storm Complete Set
08/06/2020 Letter INSPECTION SUMMARY

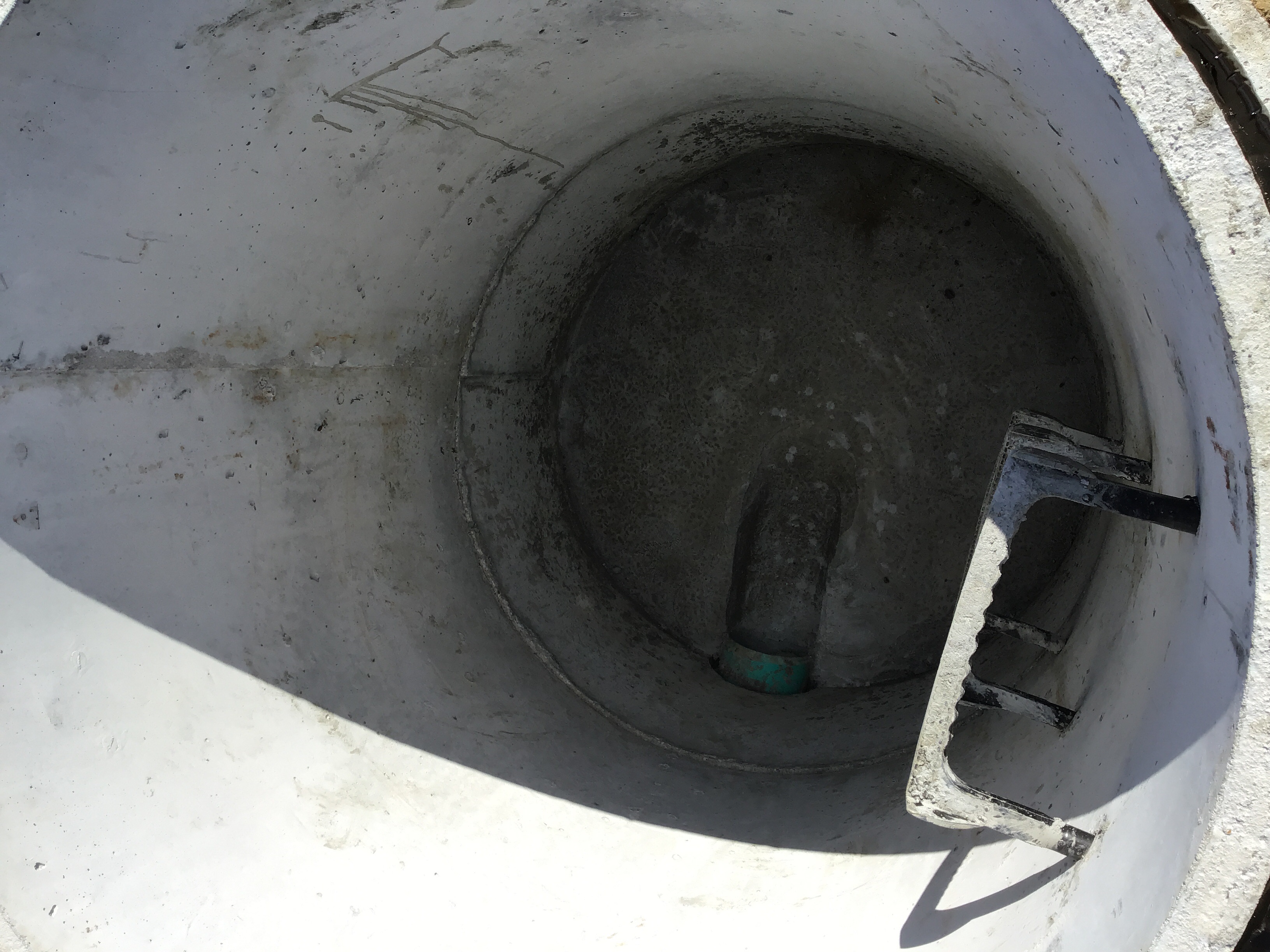

08/06/2020 MH 60-271.jpeg
08/06/2020 Letter INSPECTION SUMMARY
08/06/2020 Approved Plans Napa Valley 4th Plat Sanitary Complete Set electronically approved 8.6.20
08/06/2020 Approved Plans Napa Valley 4th Plat Water Complete Set electronically approved 8.6.20
08/06/2020 Napa Valley 4th Plat Street & Storm Complete Set Electronically approved 8_6_20
08/07/2020 image.jpg
08/07/2020 Letter INSPECTION SUMMARY
08/10/2020 Letter INSPECTION SUMMARY
08/10/2020 Letter INSPECTION SUMMARY
08/11/2020 Letter INSPECTION SUMMARY
08/11/2020 SS line A.jpeg
08/11/2020 SS line A.jpeg0
08/11/2020 SS line A.jpeg1
08/12/2020 Sanitary line A.jpg
08/12/2020 SS service line.jpg
08/12/2020 SS MH A-1.jpg
08/12/2020 SS line B service.jpg
08/12/2020 Letter INSPECTION SUMMARY
08/13/2020 Letter INSPECTION SUMMARY
08/14/2020 Lot 157 SS stub and trench check.jpg
08/14/2020 Letter INSPECTION SUMMARY
08/17/2020 Letter INSPECTION SUMMARY
08/17/2020 Letter INSPECTION SUMMARY
08/19/2020 Letter INSPECTION SUMMARY
08/19/2020 SS MH A-2.jpeg
08/20/2020 Wye Service lot 164.jpg
08/20/2020 Letter INSPECTION SUMMARY
08/24/2020 Letter INSPECTION SUMMARY
08/24/2020 Curb Inlet 1-1.jpeg

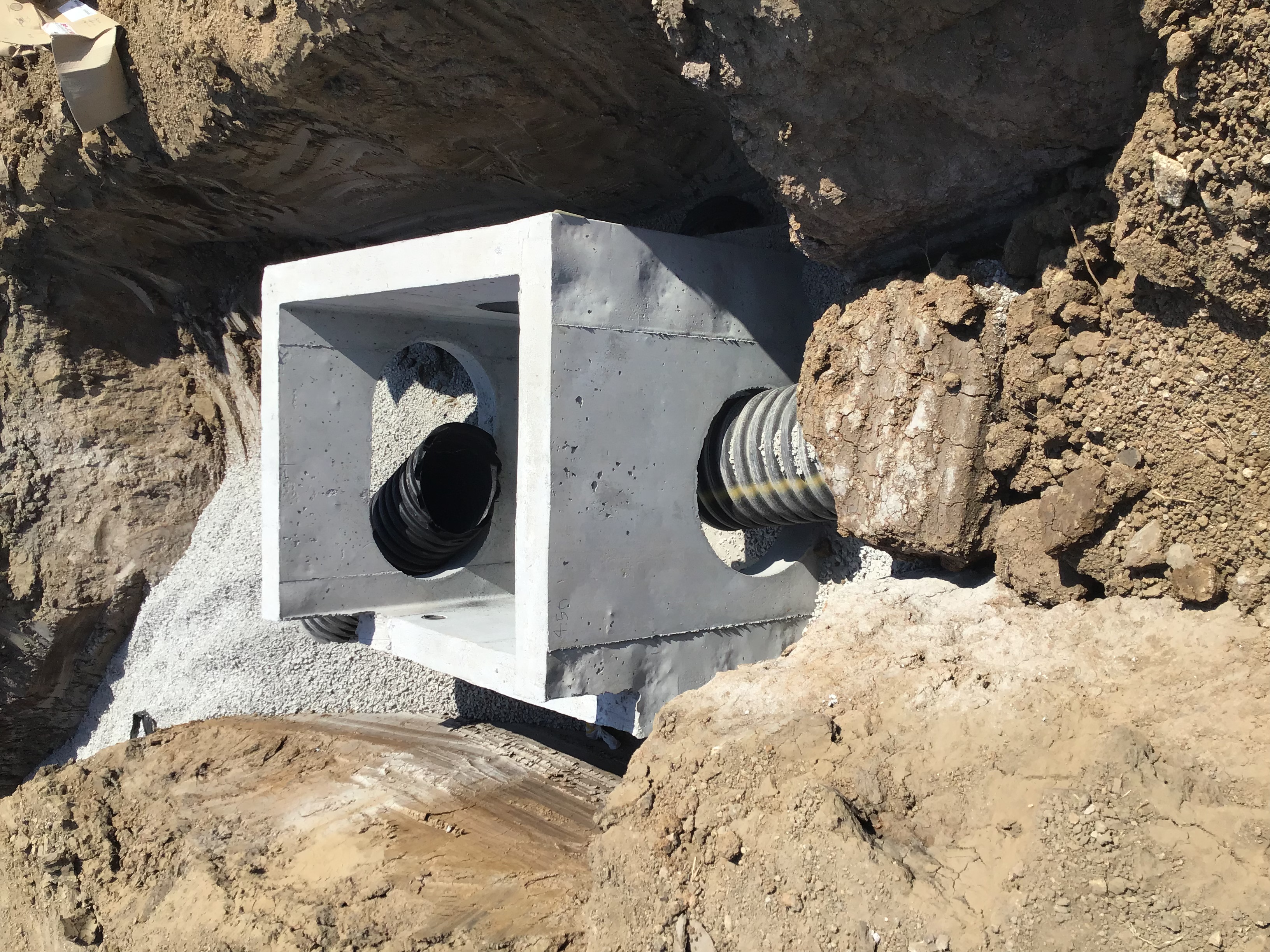

08/24/2020 Storm line 1.jpeg
08/24/2020 Curb inlet 1-2.jpeg
08/25/2020 Storm line 1.jpg
08/25/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/27/2020 SS MH A-2 invert.jpg
08/27/2020 SS MH B-1.jpg
08/27/2020 Letter INSPECTION SUMMARY
08/28/2020 Letter INSPECTION SUMMARY
10/02/2020 FLY ASH INSTALL.jpg
10/02/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/08/2020 Letter INSPECTION SUMMARY
10/21/2020 Letter INSPECTION SUMMARY
10/21/2020 Curb Testing.jpeg
10/21/2020 Curb install.jpeg
10/21/2020 Curb install.jpg
11/02/2020 Letter INSPECTION SUMMARY
11/03/2020 Letter INSPECTION SUMMARY

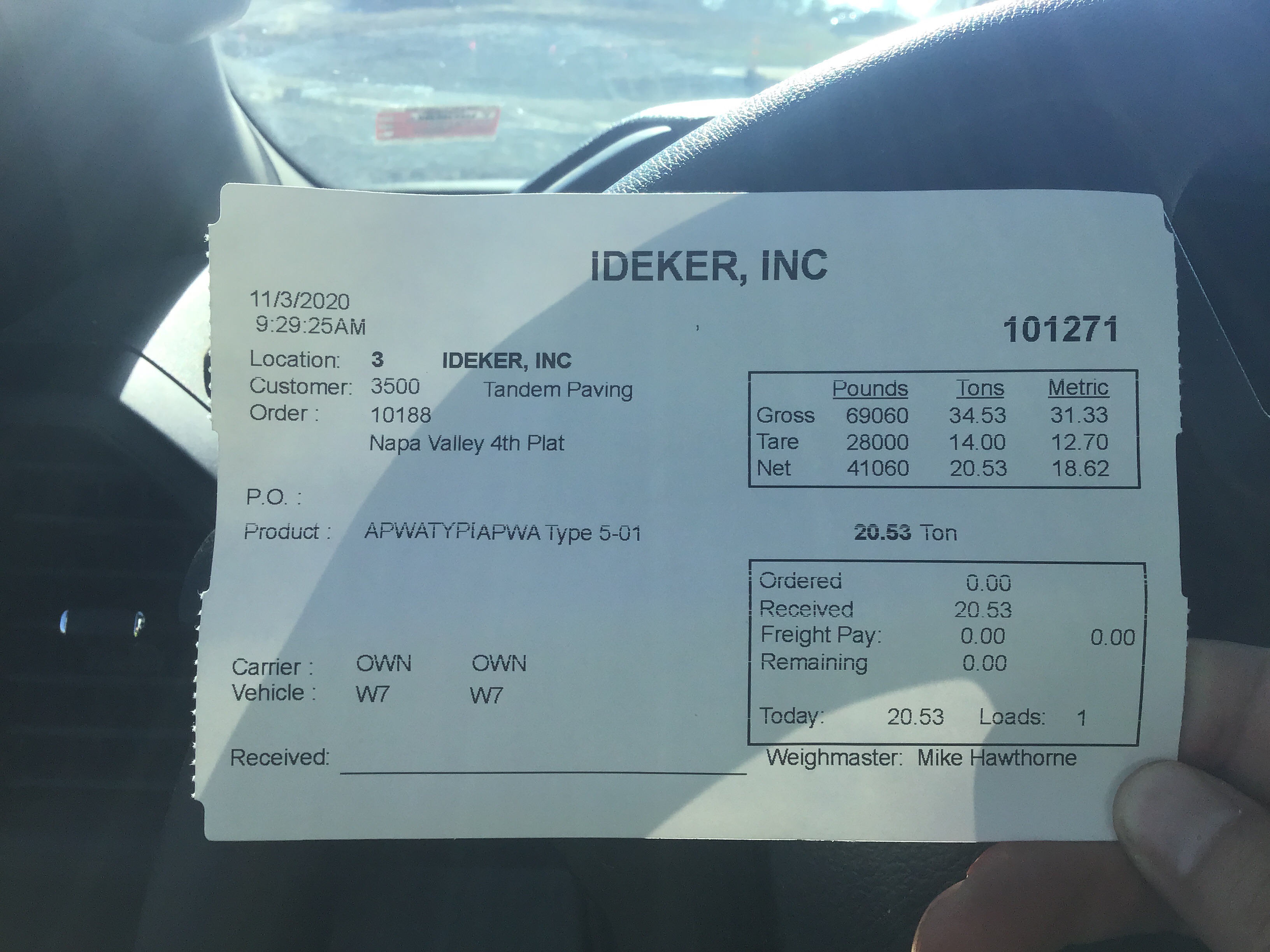

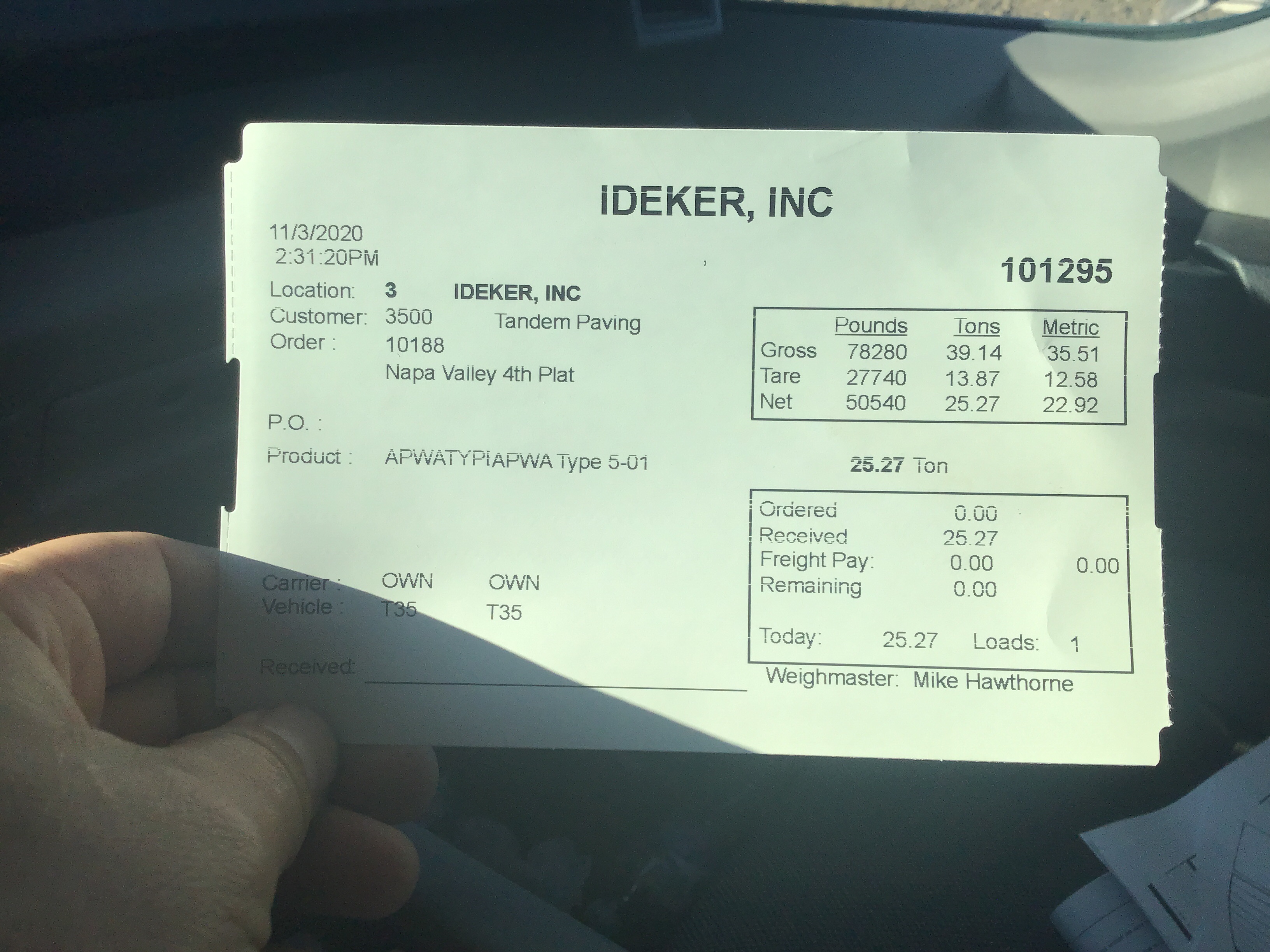

11/03/2020 BASE ASPHALT TICKET.jpg
11/03/2020 Letter INSPECTION SUMMARY
11/03/2020 Letter INSPECTION SUMMARY
11/03/2020 Asphalt Surface ticket .jpg

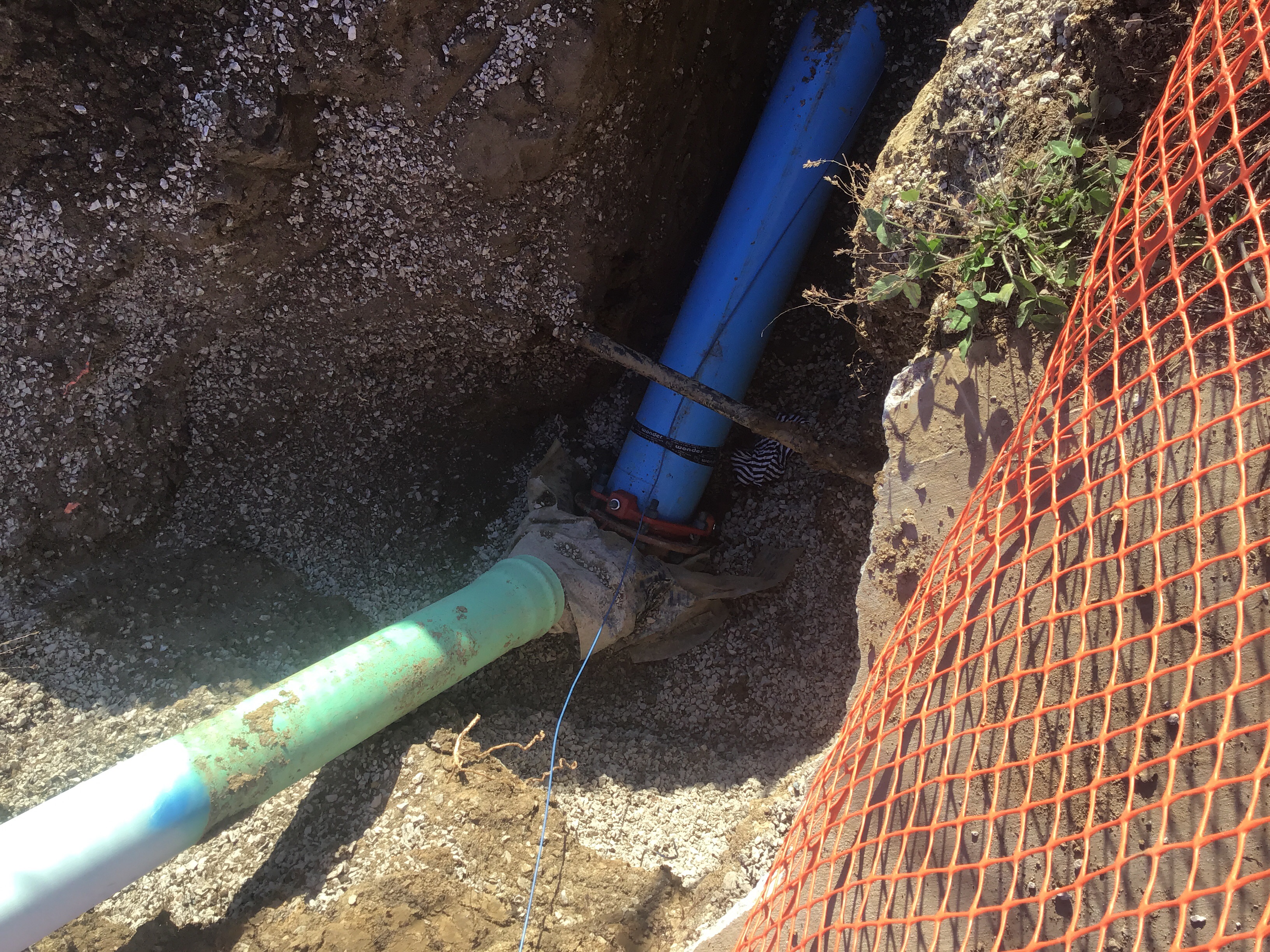

11/03/2020 Water line tie in 7+78.49.jpg
11/03/2020 Letter INSPECTION SUMMARY
11/04/2020 Letter INSPECTION SUMMARY
11/04/2020 Letter INSPECTION SUMMARY
11/04/2020 Letter INSPECTION SUMMARY
11/04/2020 Letter INSPECTION SUMMARY
11/05/2020 Letter INSPECTION SUMMARY
11/05/2020 95246F7F-3550-496A-932C-49F7218A4842.jpeg
11/09/2020 Letter INSPECTION SUMMARY
11/09/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter INSPECTION SUMMARY

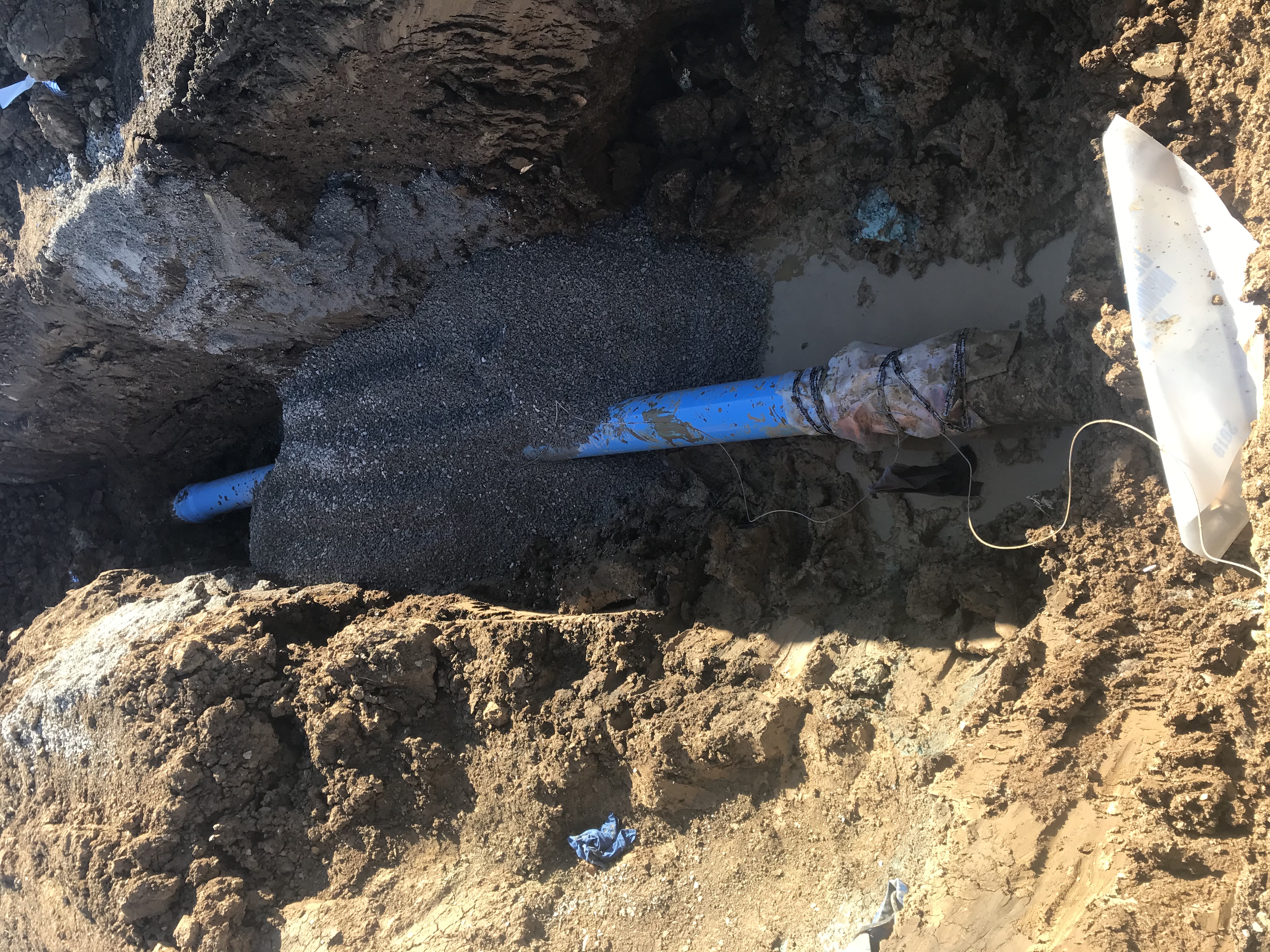

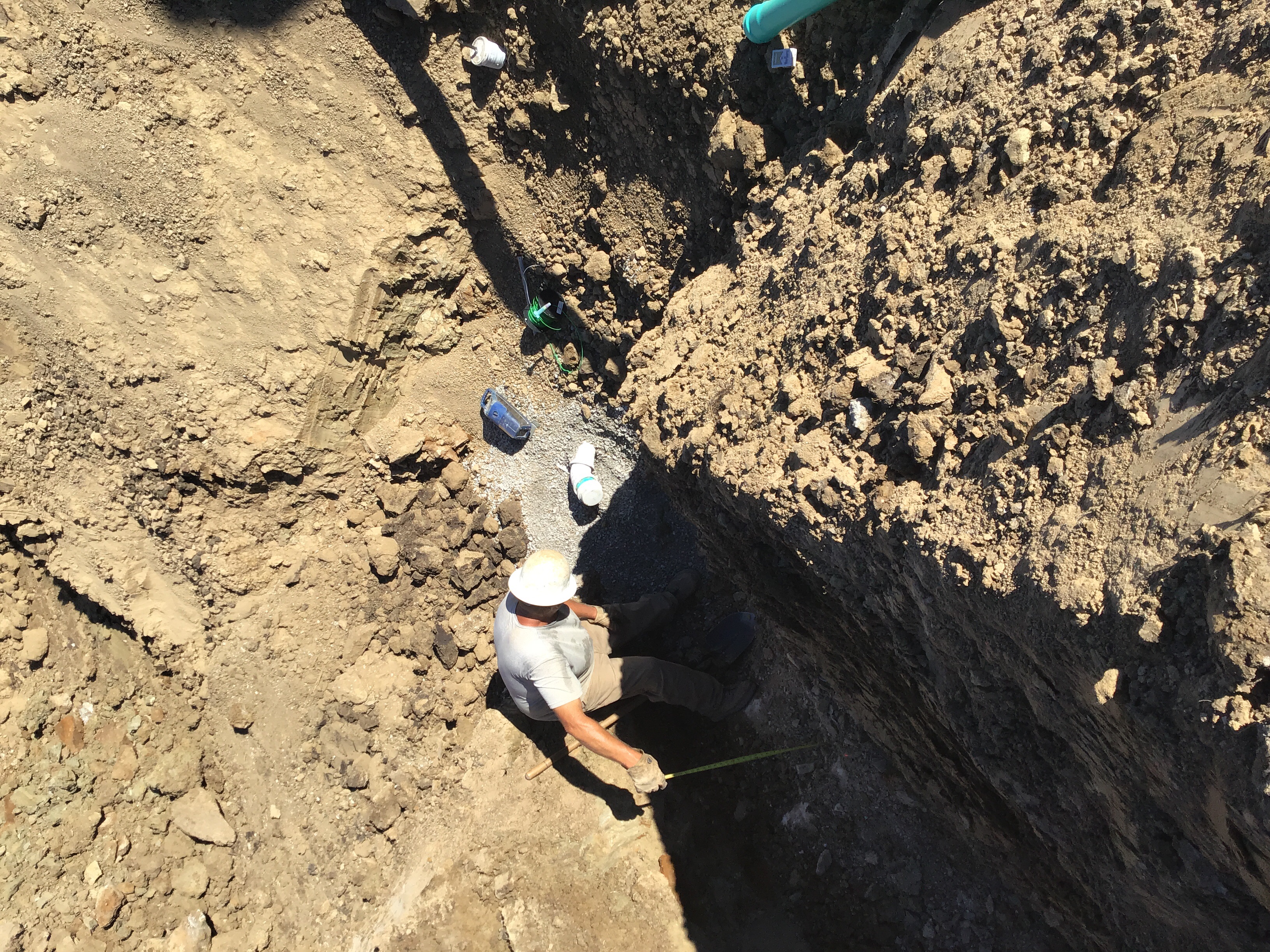

11/17/2020 Water line west tie in.jpeg
11/30/2020 Letter INSPECTION SUMMARY
01/20/2021 Plans STREET AND STORM ASBUILTS
01/20/2021 Plans SANITARY ASBUILTS
01/20/2021 Plans WATER ASBUILTS
01/25/2021 Letter INSPECTION SUMMARY
01/25/2021 Letter INSPECTION SUMMARY
02/08/2021 Plans STREET AND STORM - as built
04/01/2021 Cylinder Breaks 10.28.20
04/01/2021 Cylinder Breaks 11.18.20
04/01/2021 K37124 - Proctor Compaction - 8-13-2020
04/01/2021 K37128 - Proctor Compaction - 8-13-2020
04/01/2021 K37144 - In-Place Density Testing - 8-25-2020
04/01/2021 K37370 - In-Place Density Testing - 9-15-2020
04/01/2021 K37528 - In-Place Density Testing - 9-22-2020
04/01/2021 K37613 - Proctor Compaction - 9-28-2020
04/01/2021 K37614 - Proctor Compaction - 9-28-2020
04/01/2021 K37615 - Proctor Compaction - 9-28-2020
04/01/2021 K37744 - In-Place Density Testing - 10-2-2020
04/01/2021 K37876 - In-Place Density Testing - 10-7-2020
04/01/2021 K37954 - In-Place Density Testing - 10-9-2020
04/01/2021 WO#1K00914 - City of Lees Summit
04/01/2021 WO#1K00980 - City of Lees Summit
04/01/2021 10-21-20 173841 4509MC SHOWME READYMIX
05/24/2021 Napa Valley 4th - Maintenance Bond (Sanitary, water, storm)
11/15/2021 Napa Valley 4th Plat Punch List
11/15/2021 Napa Valley 4th Plat Substantial Completion
11/16/2021 Napa Valley 4th Plat Final Affidavit and Agreement
12/03/2021 Letter DE-Certificate of Final Acceptance (Commercial)
12/03/2021 Napa Valley 4th Plat Final Acceptance
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
12/13/2021 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
