Summary

PRSUBD20191873
Public Infrastructure
Final Acceptance
DJ23 INVESTMENTS LLC
DEVELOPMENT COMPLETE
RESERVE AT STONEY CREEK 4TH PLAT SUBDIVIDISION IMPROVEMENTS
07/15/2019
10/15/2019
02/17/2023
Locations
Contacts
Not shown for privacy reasons.
DJ23 INVESTMENTS LLC, Address:7200 W 132ND ST
ANDERSON KEYANA I, Address:1920 SW HIGHTOWN DR
BROWN XAVIER A & GEENA R, Address:1924 SW HIGHTOWN DR
ROSE KENDRICK SEPERATE PROP TRUST - 2014 DATED 02-14-2014, Address:1928 SW HIGHTOWN DR
AVITAL HOMES LLC, Address:15729 BALLENTINE ST
STONEY CREEK ESTATES HOMEOWNERS ASSOCIATION INC, Address:120 SE 30TH ST
HOLLIDAY CHRISTOPHER, Address:1932 SW HIGHTOWN DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 01/19/2021
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $1,535.98 $1,535.98 Paid 07/15/2019
Water Insp Fee $1,886.94 $1,886.94 Paid 07/15/2019
Storm Sewer Inspection Fee $1,499.72 $1,499.72 Paid 10/03/2019
Site Grading Fee $1,517.33 $1,517.33 Paid 10/03/2019
Paved Surface Inspection Fee $6,642.10 $6,642.10 Paid 10/03/2019
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 03/09/2022
After Hours Inspections (Public Works)(Per Hour) $50.00 $50.00 Paid 03/09/2022
After Hours Inspections (Public Works)(Per Hour) $100.00 $100.00 Paid 03/14/2022
After Hours Inspections (Public Works)(Per Hour) $200.00 $200.00 Paid 03/09/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

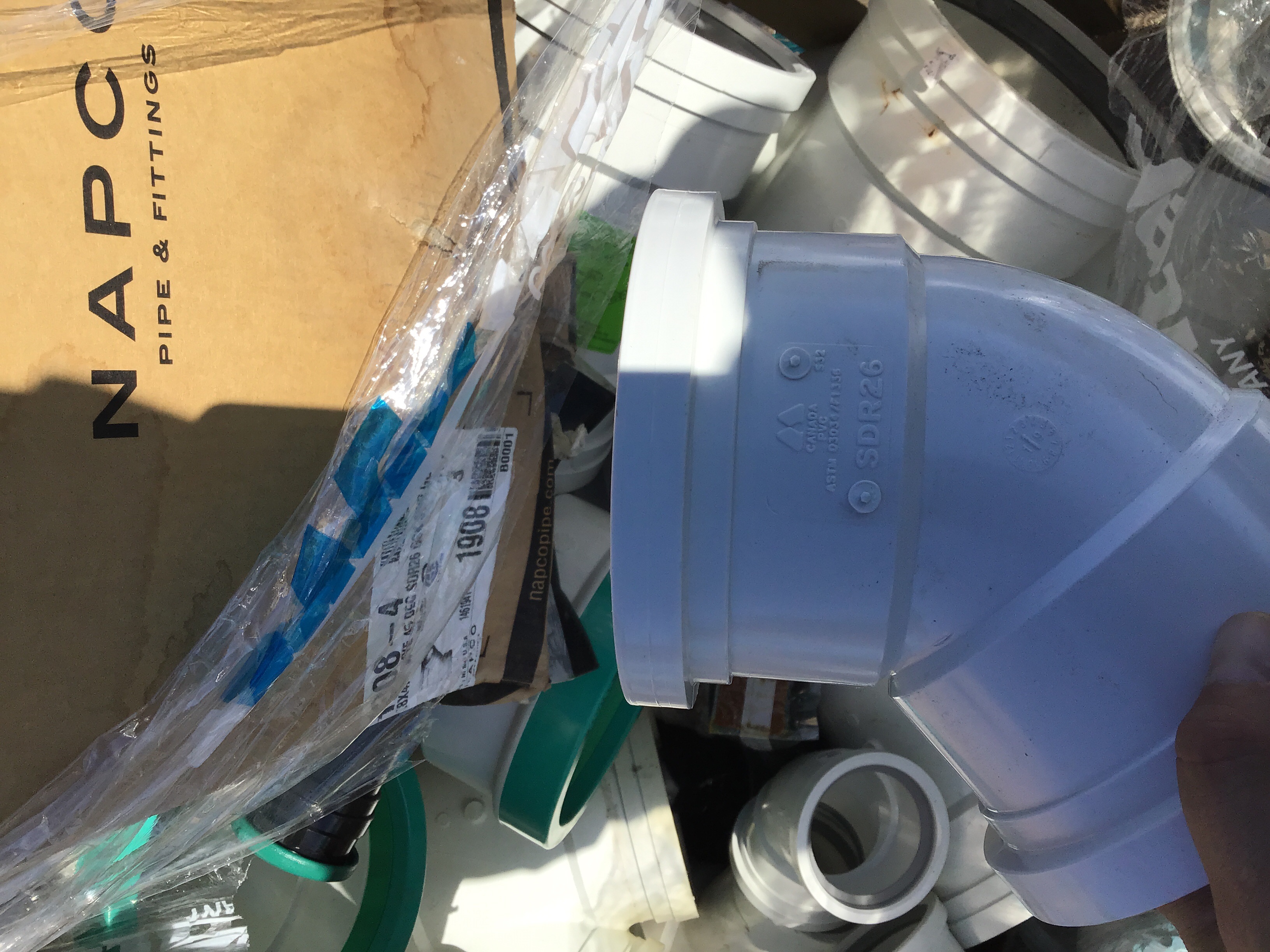

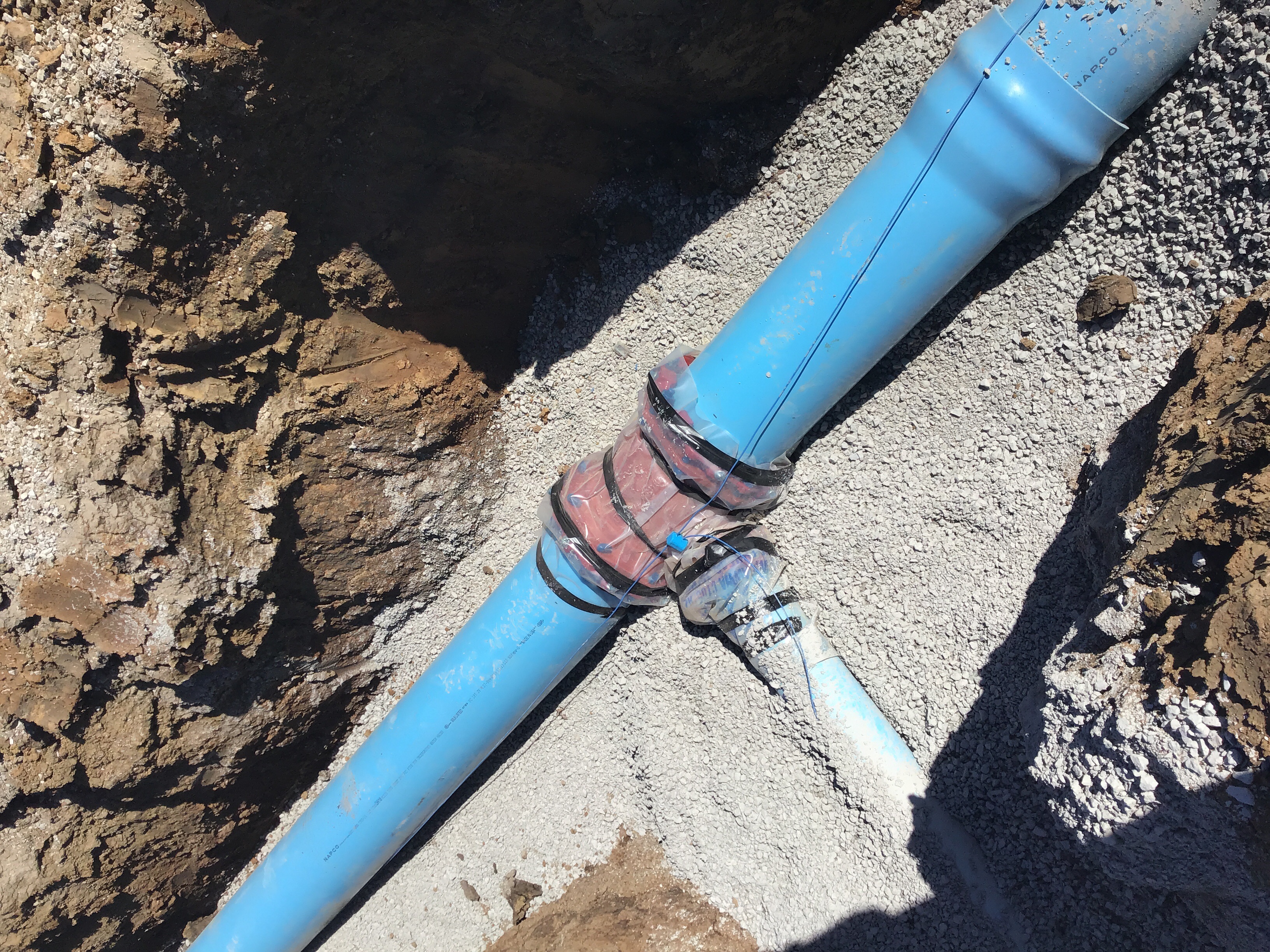

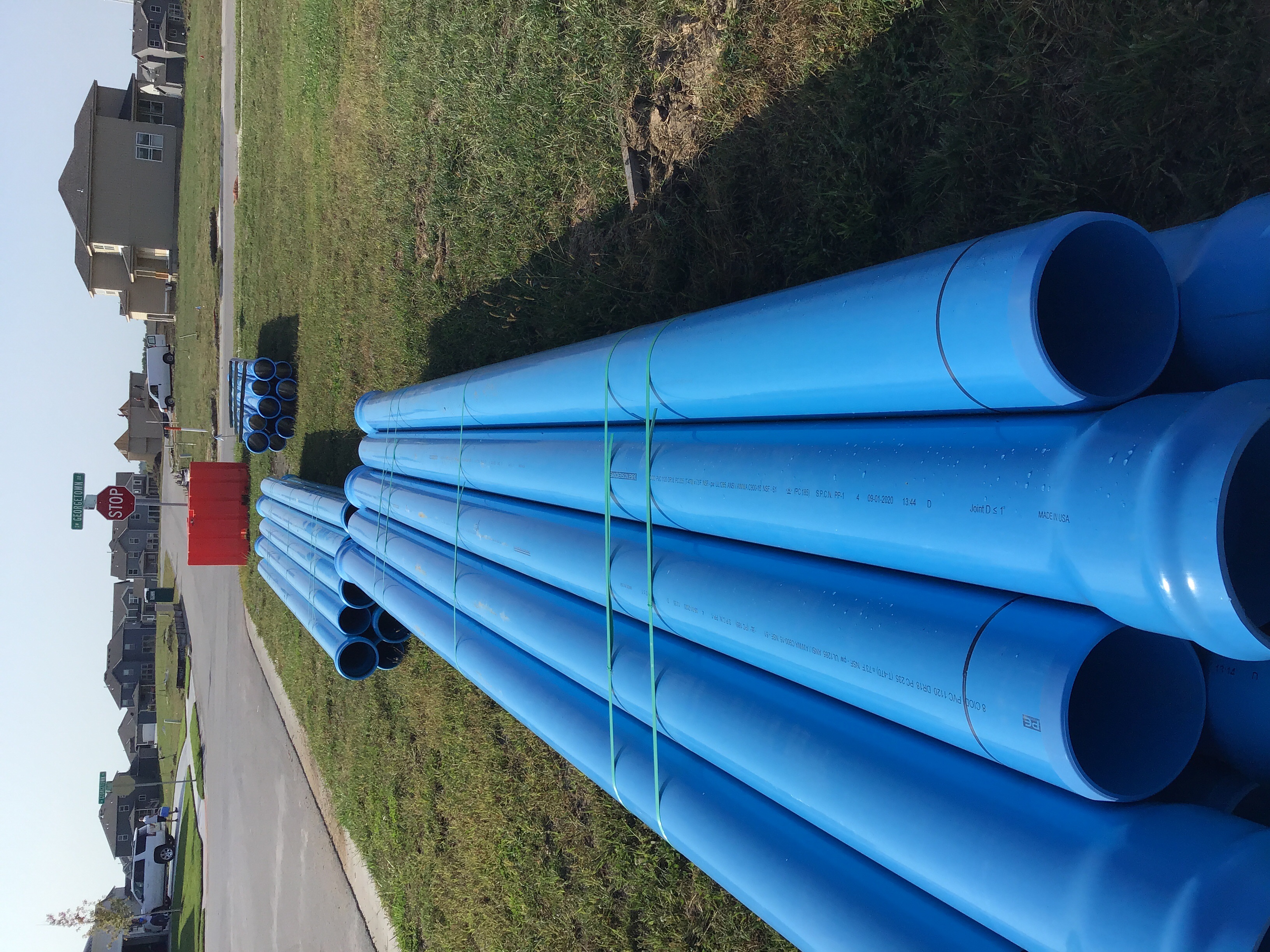

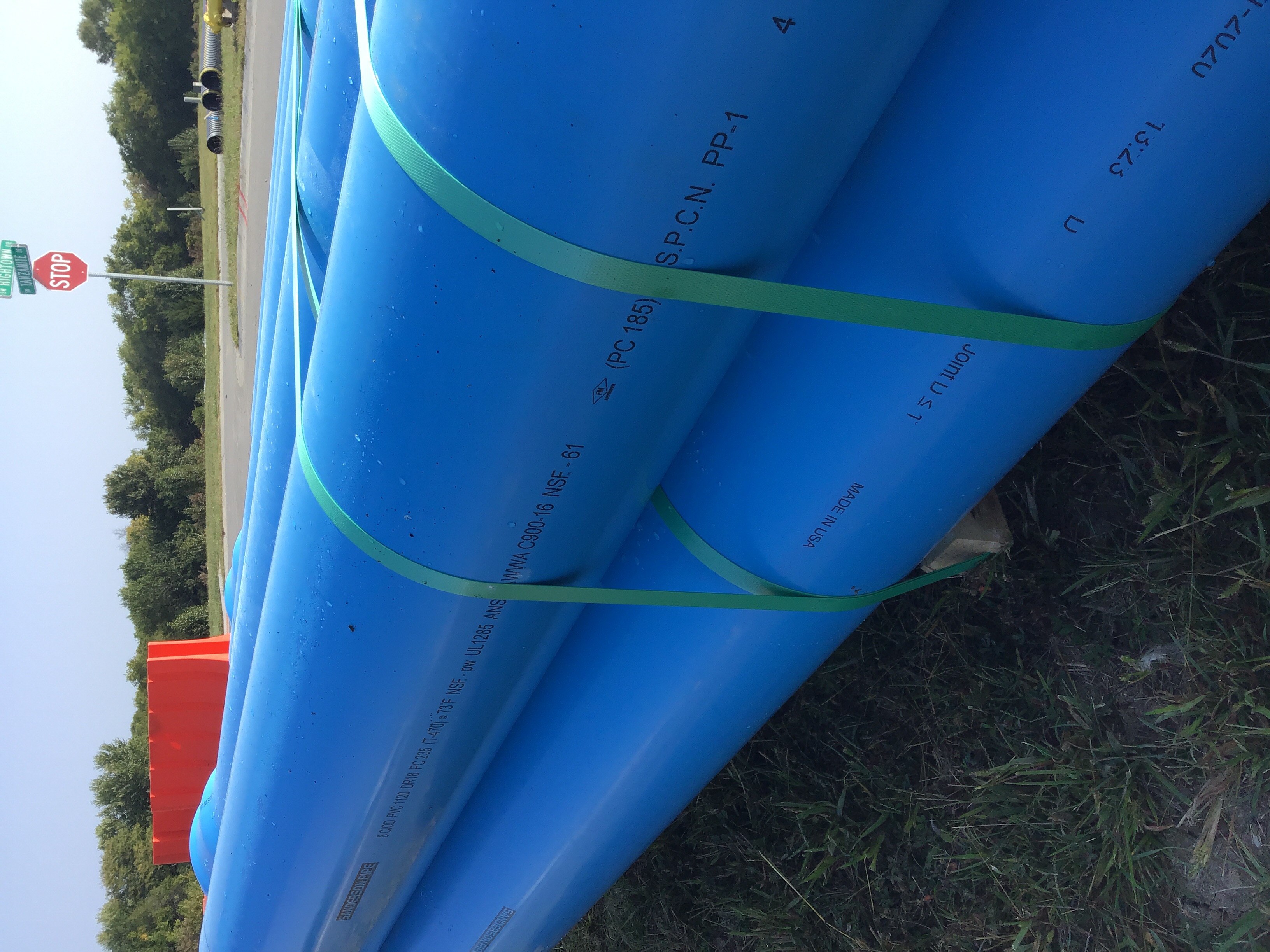

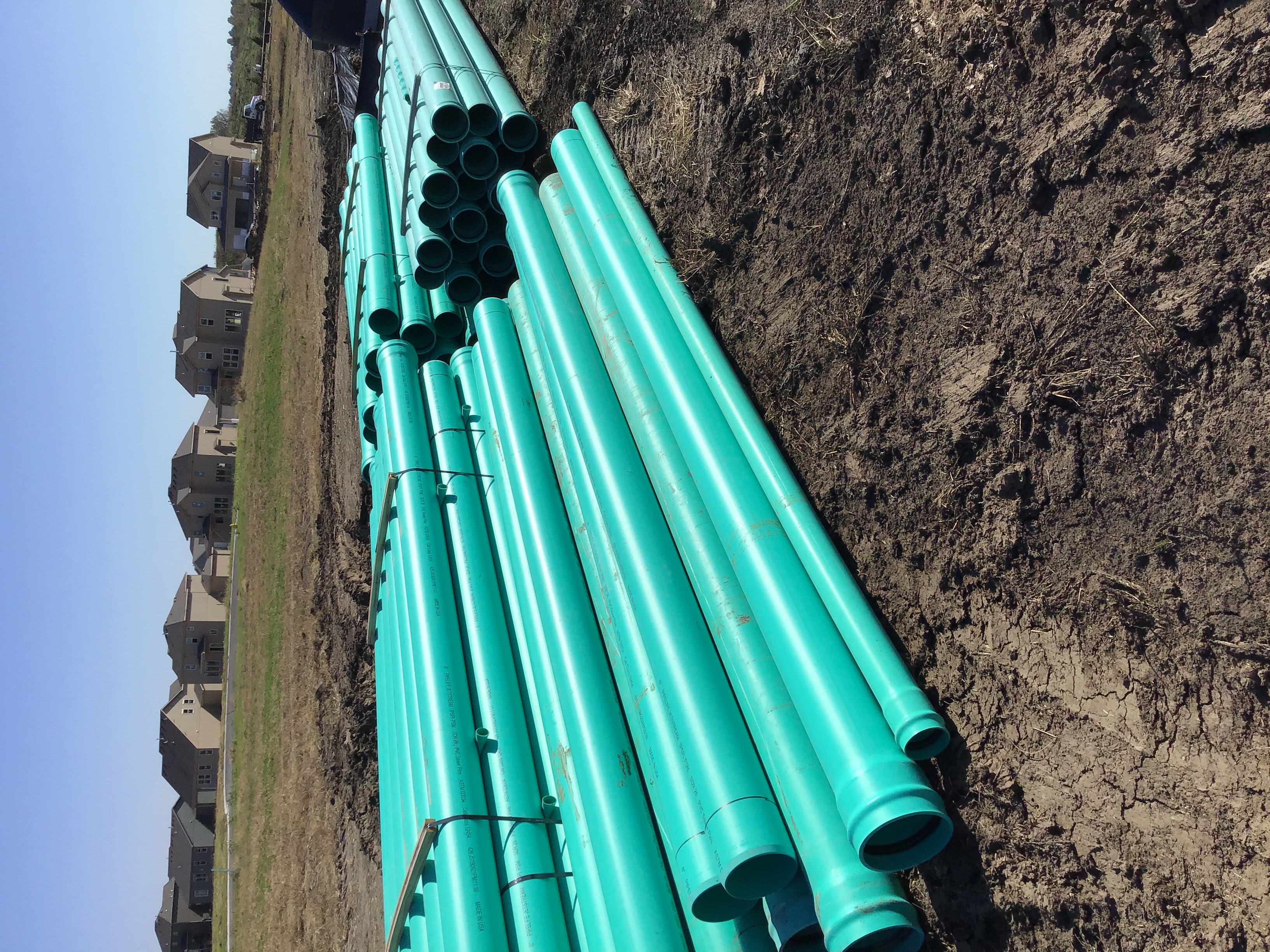

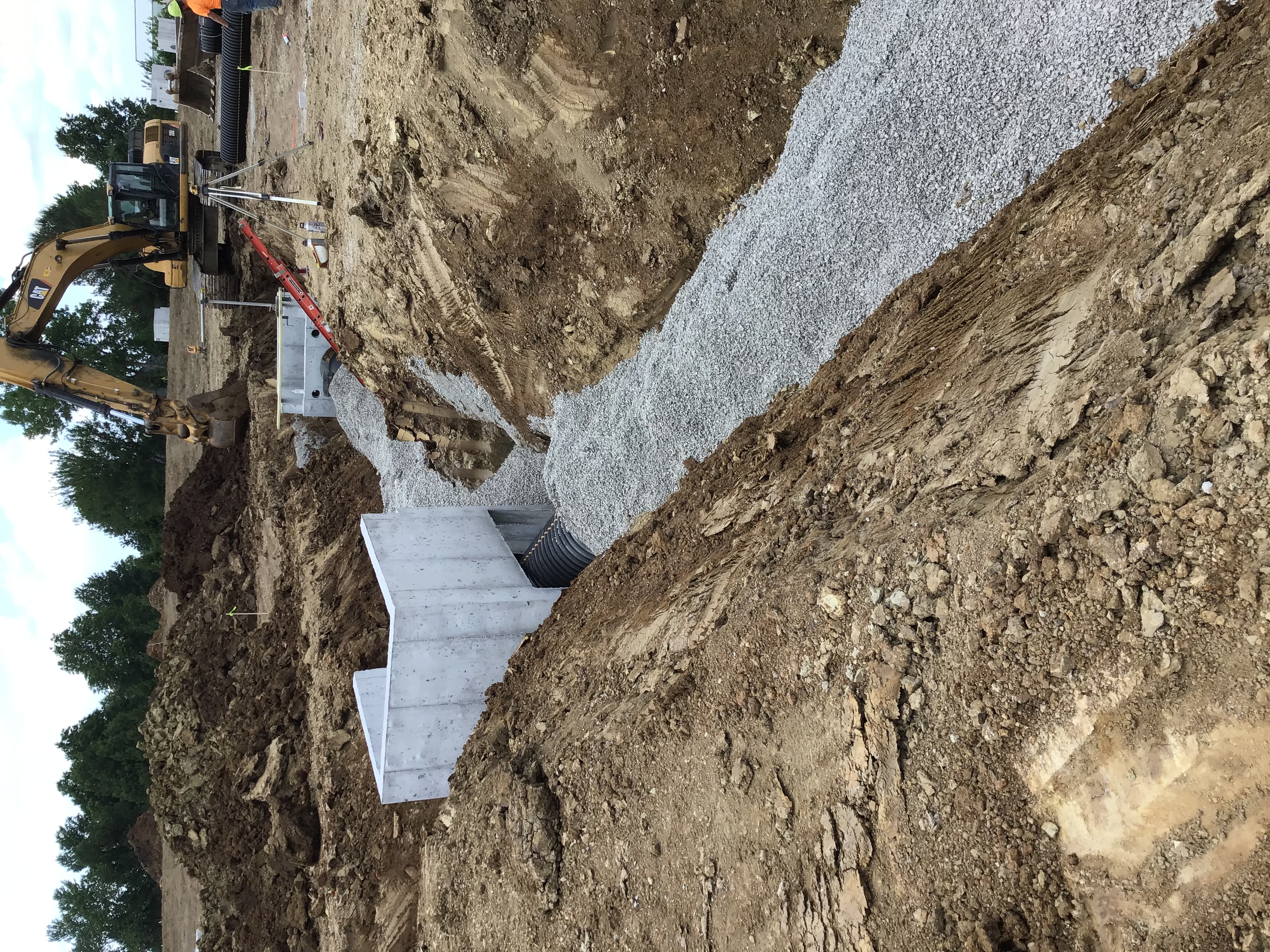

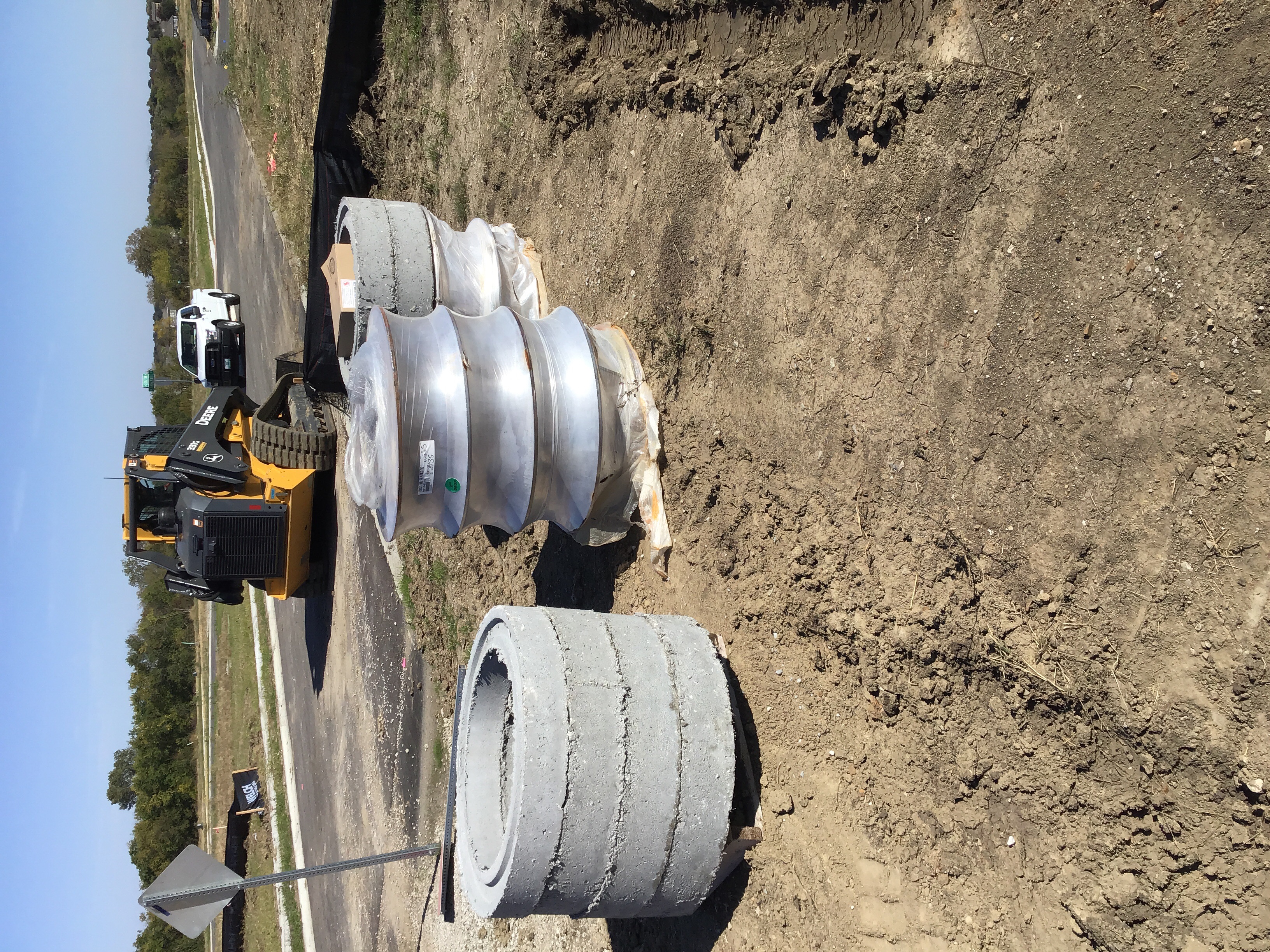

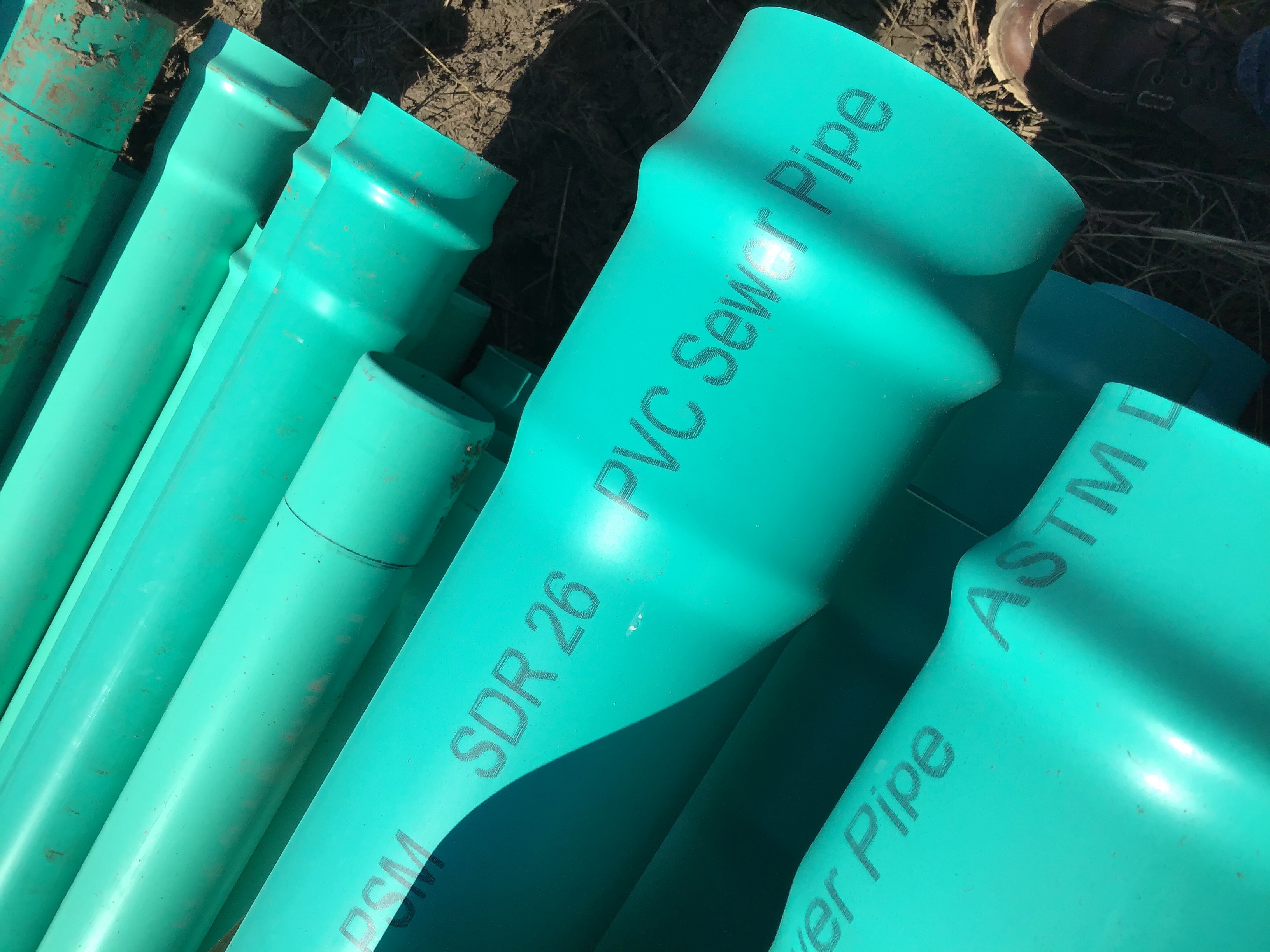

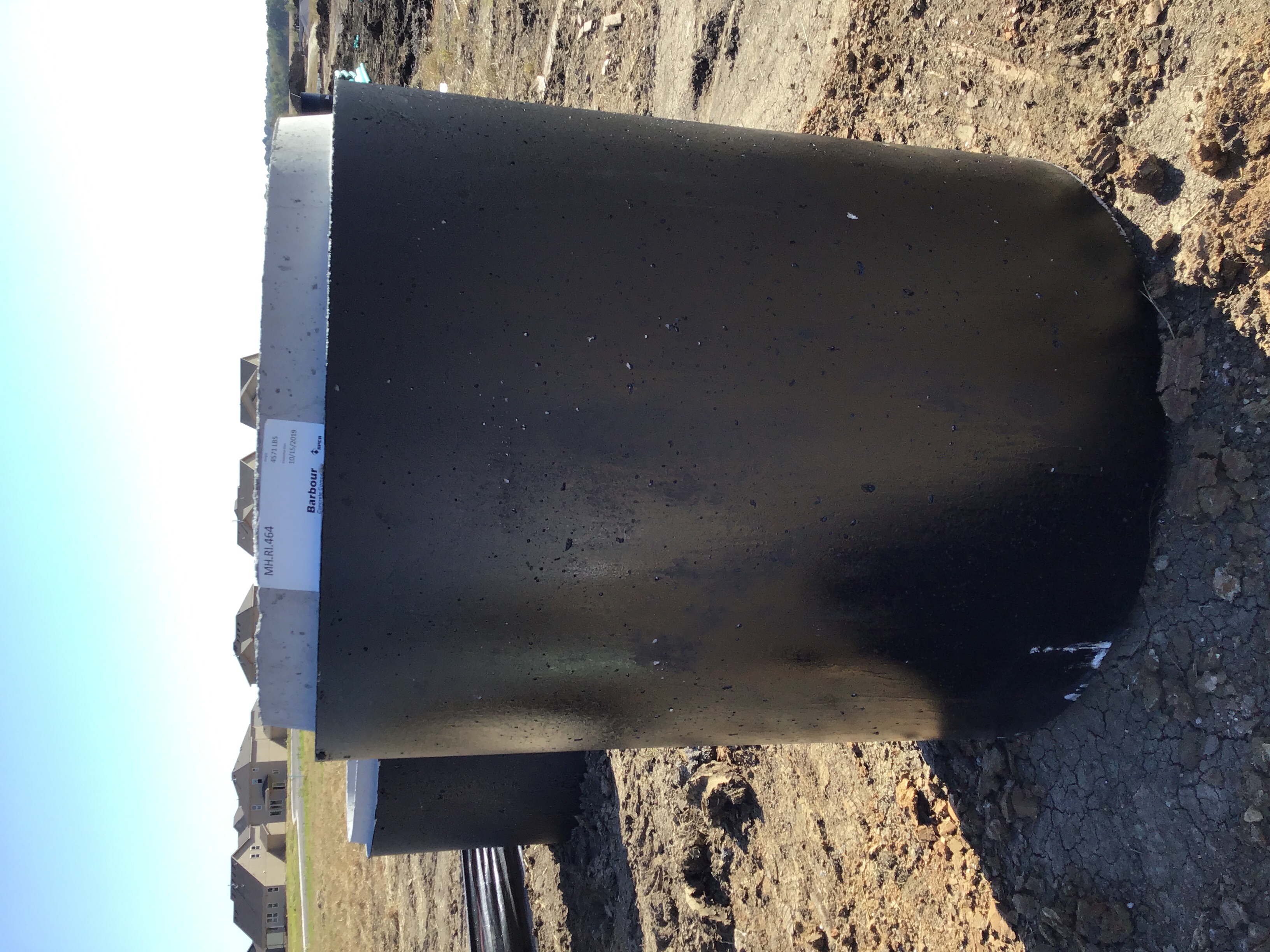

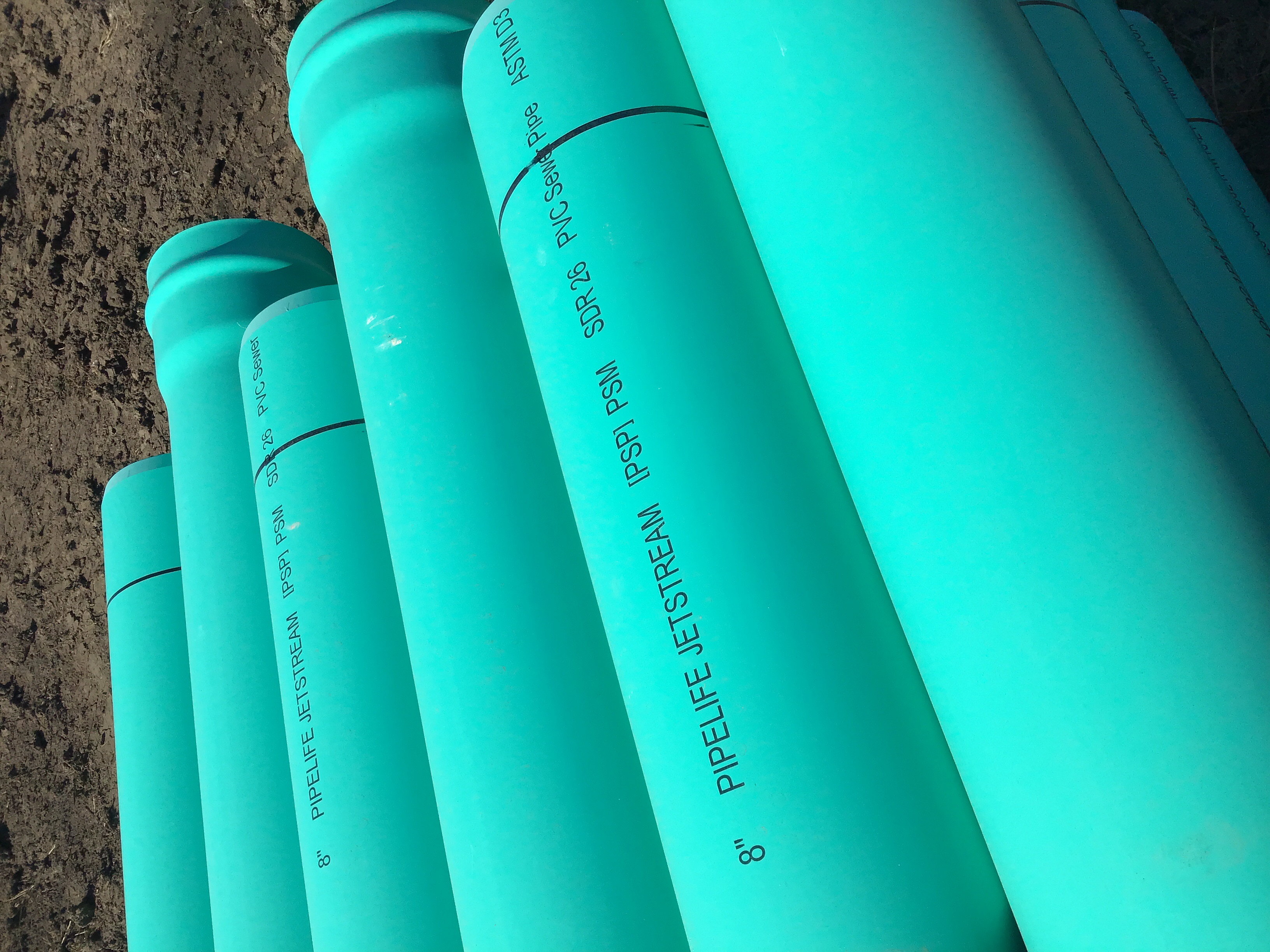

Sanitary - Material Verification Passed 10/18/2019
Misc
Informational
10/18/2019

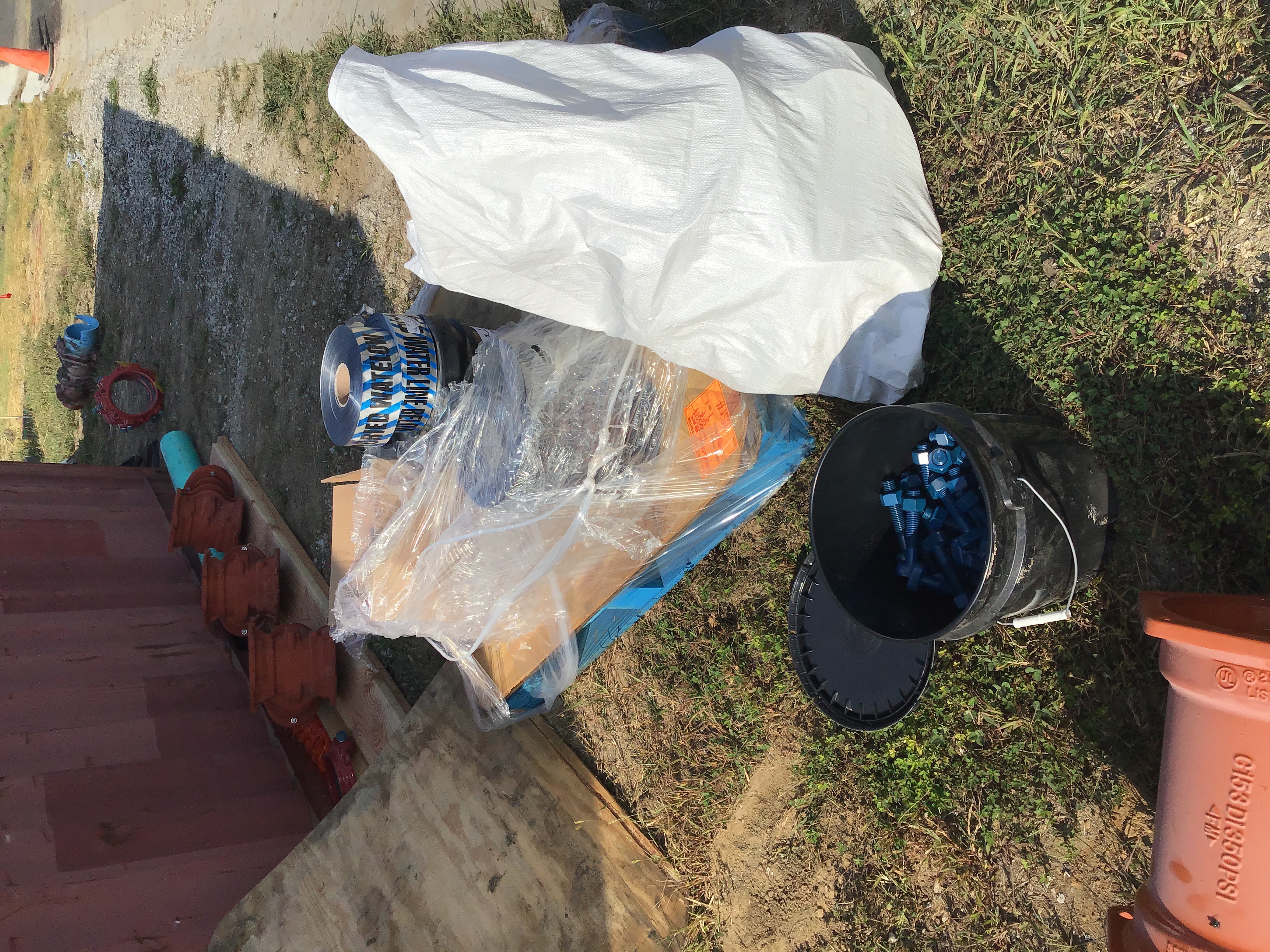

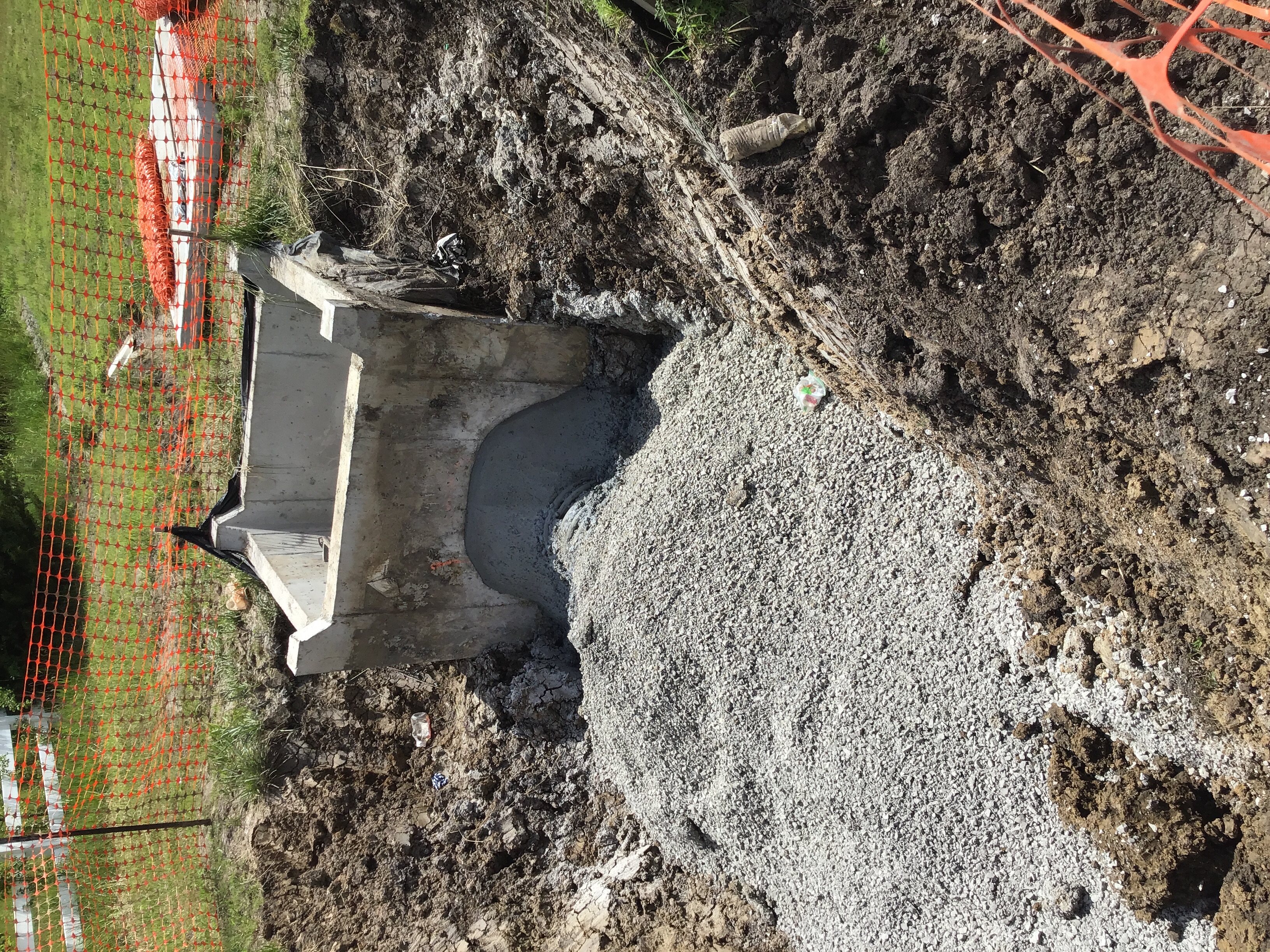

Sanitary sewer materials verified in compliance. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 10/18/2019
Misc
Informational
10/18/2019

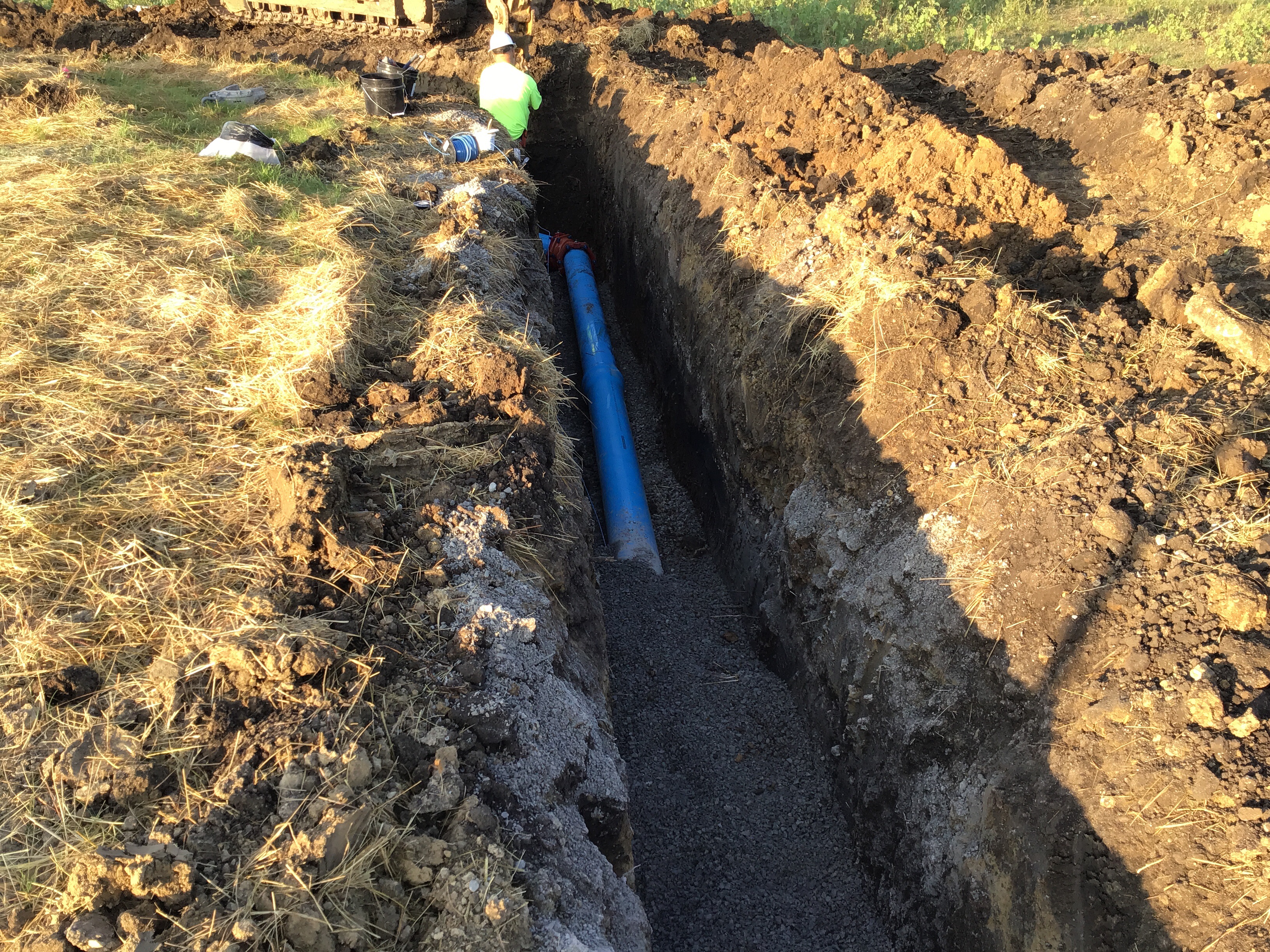

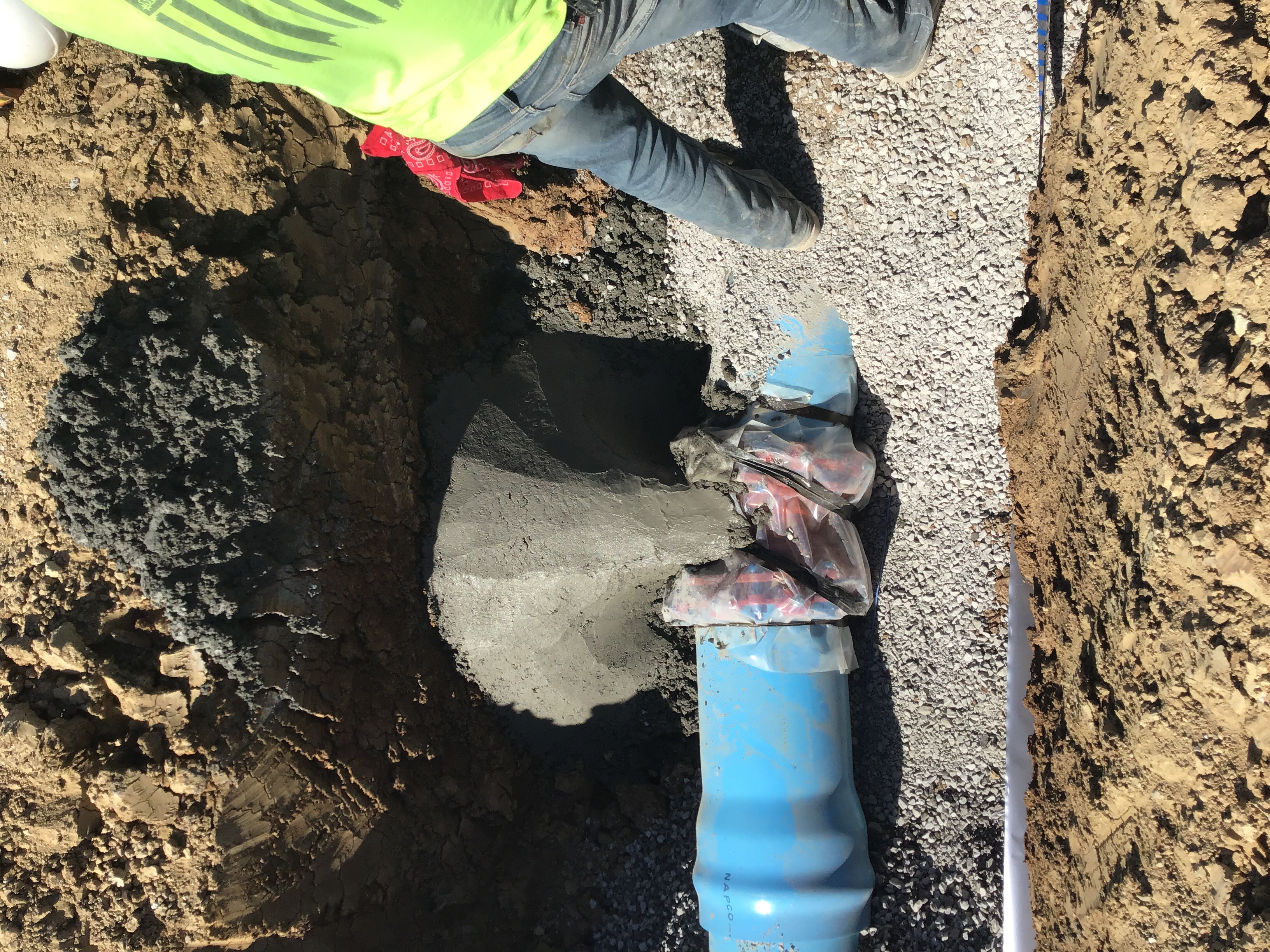

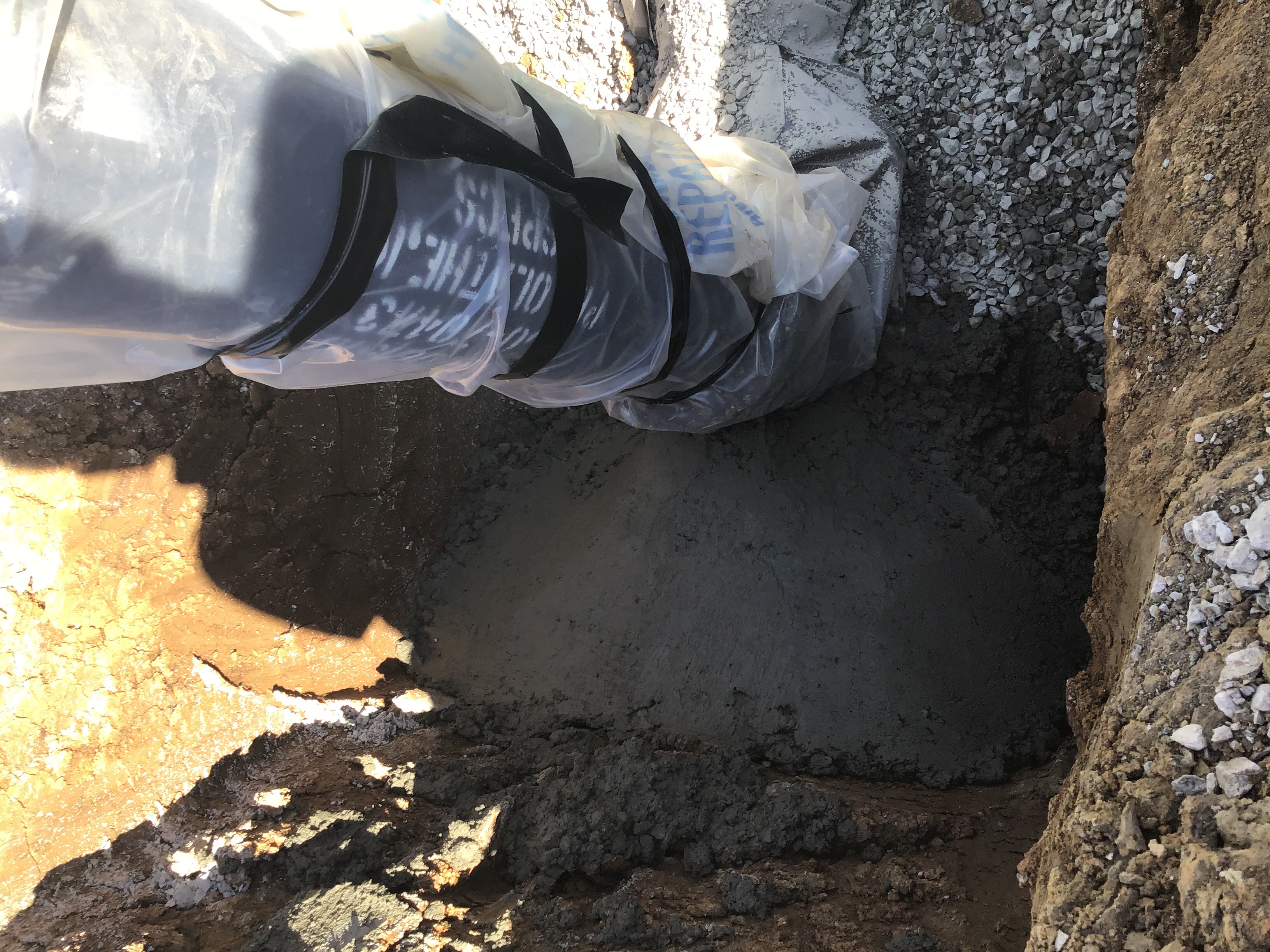

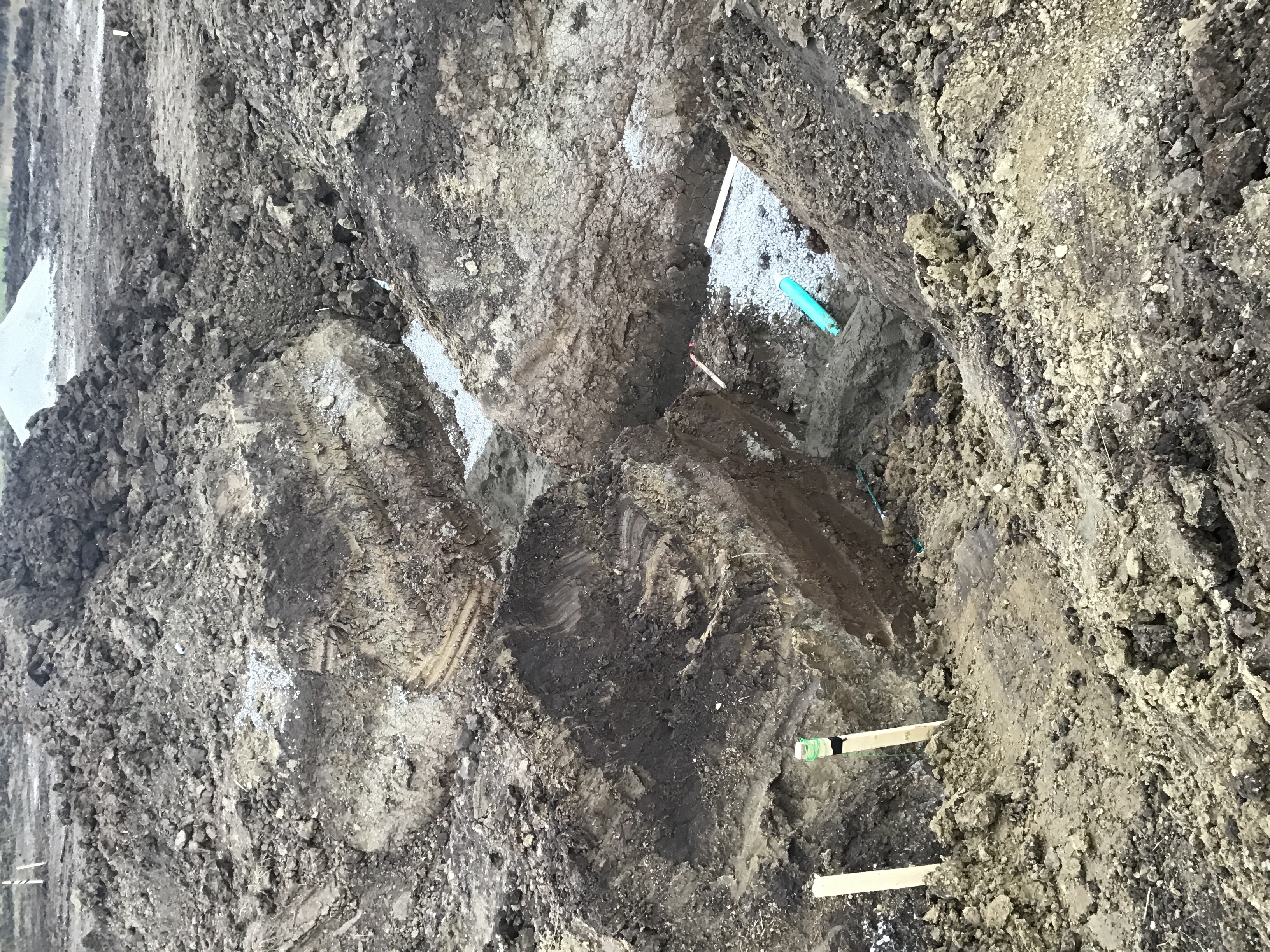

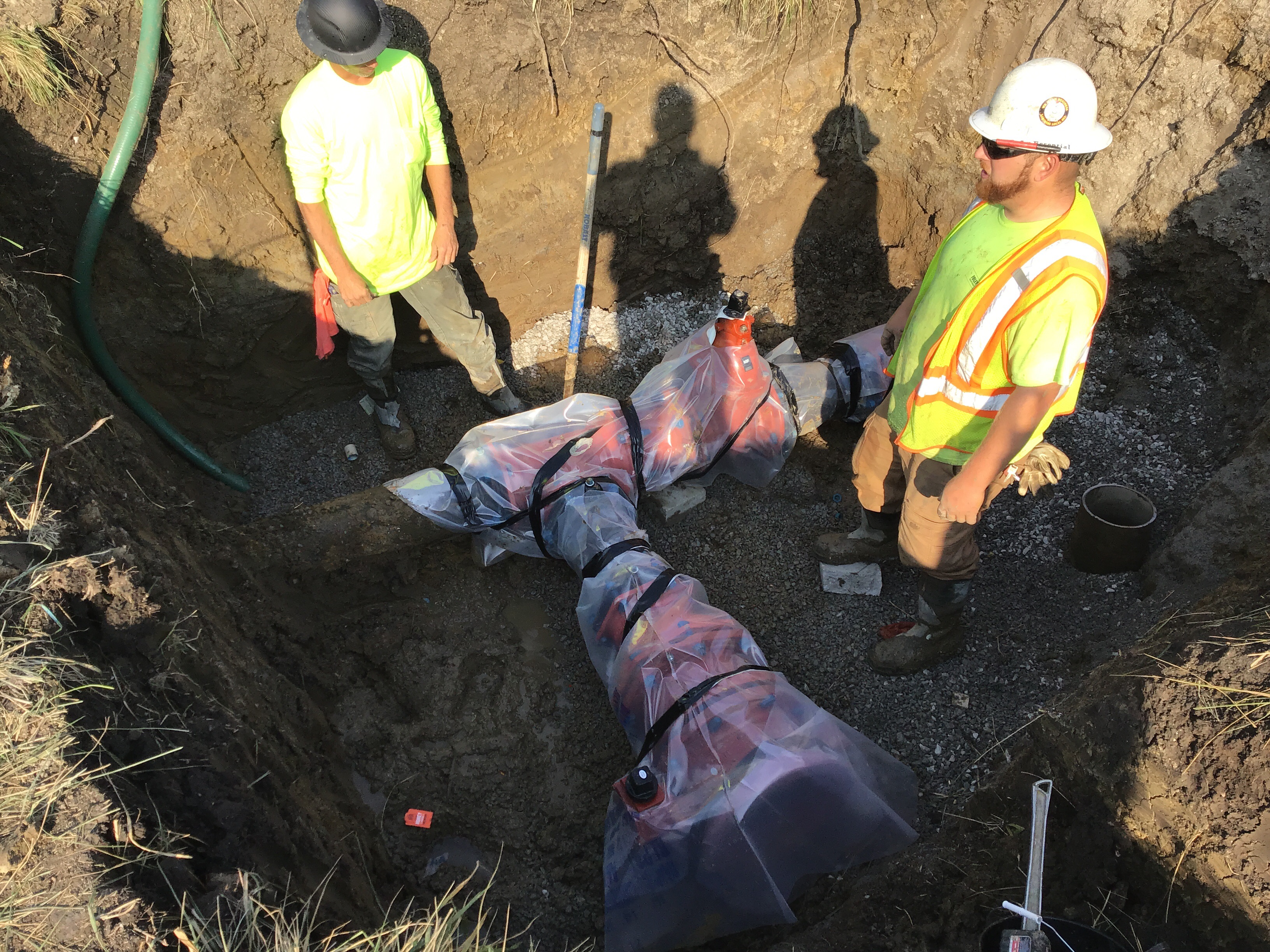

The Redford crew started the sanitary sewer install today. The crew cored into the three existing manholes. The crew installed line 1 from station 0+00 to approx station 4+00. Photos of the install are uploaded to the system.
Sanitary Sewer Construction Inspection Partial 10/21/2019 10/22/2019
Misc
Informational
10/22/2019

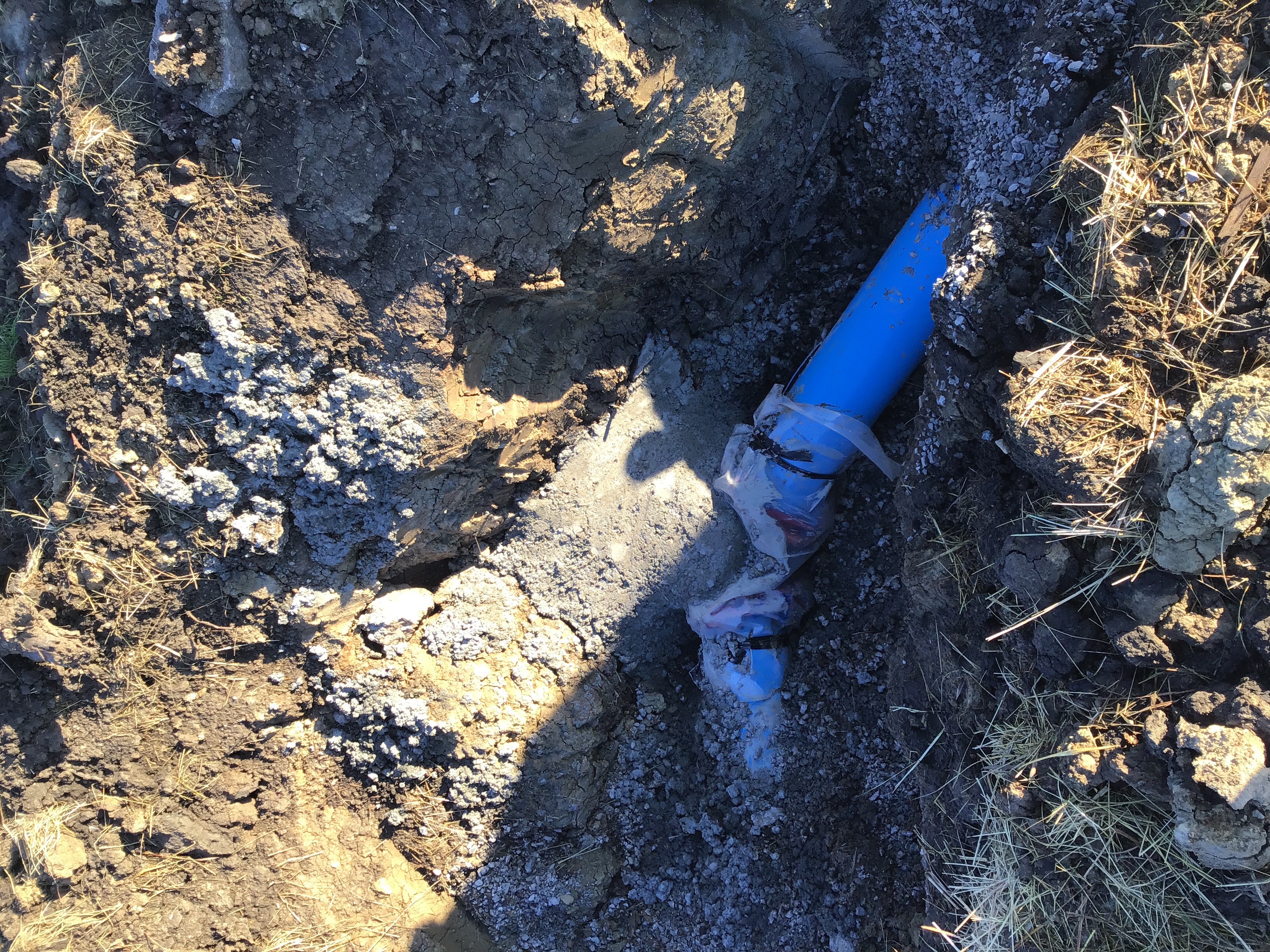

The Redford crew completed the line 1 run to MH 1-5. All the service laterals are installed and the crew plans to pour the trench checks later today. I will return for further inspection of the trench checks and service laterals tomorrow morning prior to back filling and will upload photos of the construction at that time.
Sanitary Sewer Construction Inspection Partial 10/23/2019 10/23/2019
Misc
Informational
10/23/2019
The Redford crew installed the main and service laterals from station 0+00 to 4+00. The laterals and trench checks are installed for lots 111-114 & 123-127. Photos of the laterals and trench checks are uploaded. The crew is currently setting MH 1-4 and preparing to run the line to MH 1-5. I will return later today for further inspection.

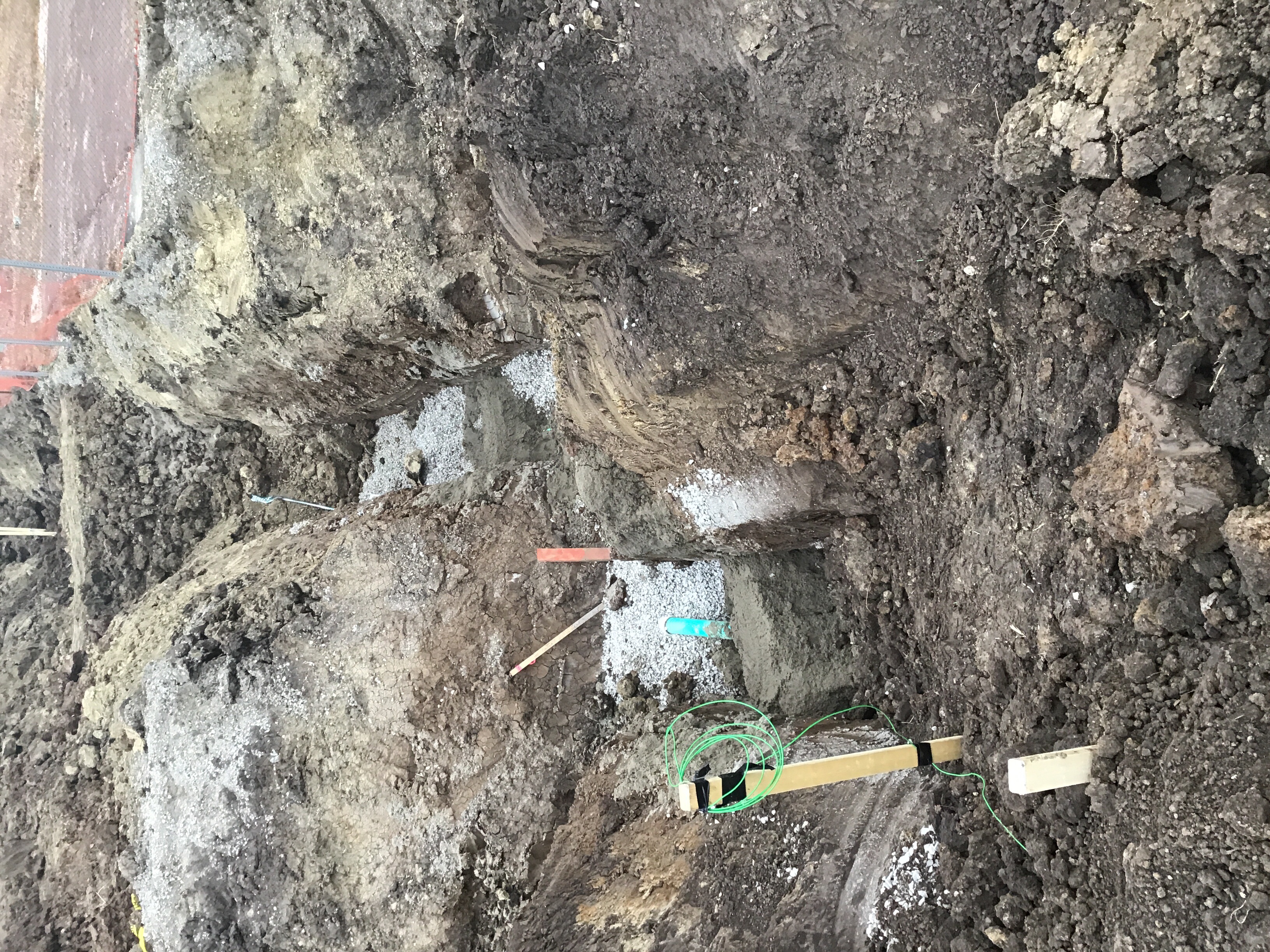

Erosion Control Inspection Failed 10/15/2019 03/19/2020
Miscellaneous Correction
Corrective Action Required
03/19/2020

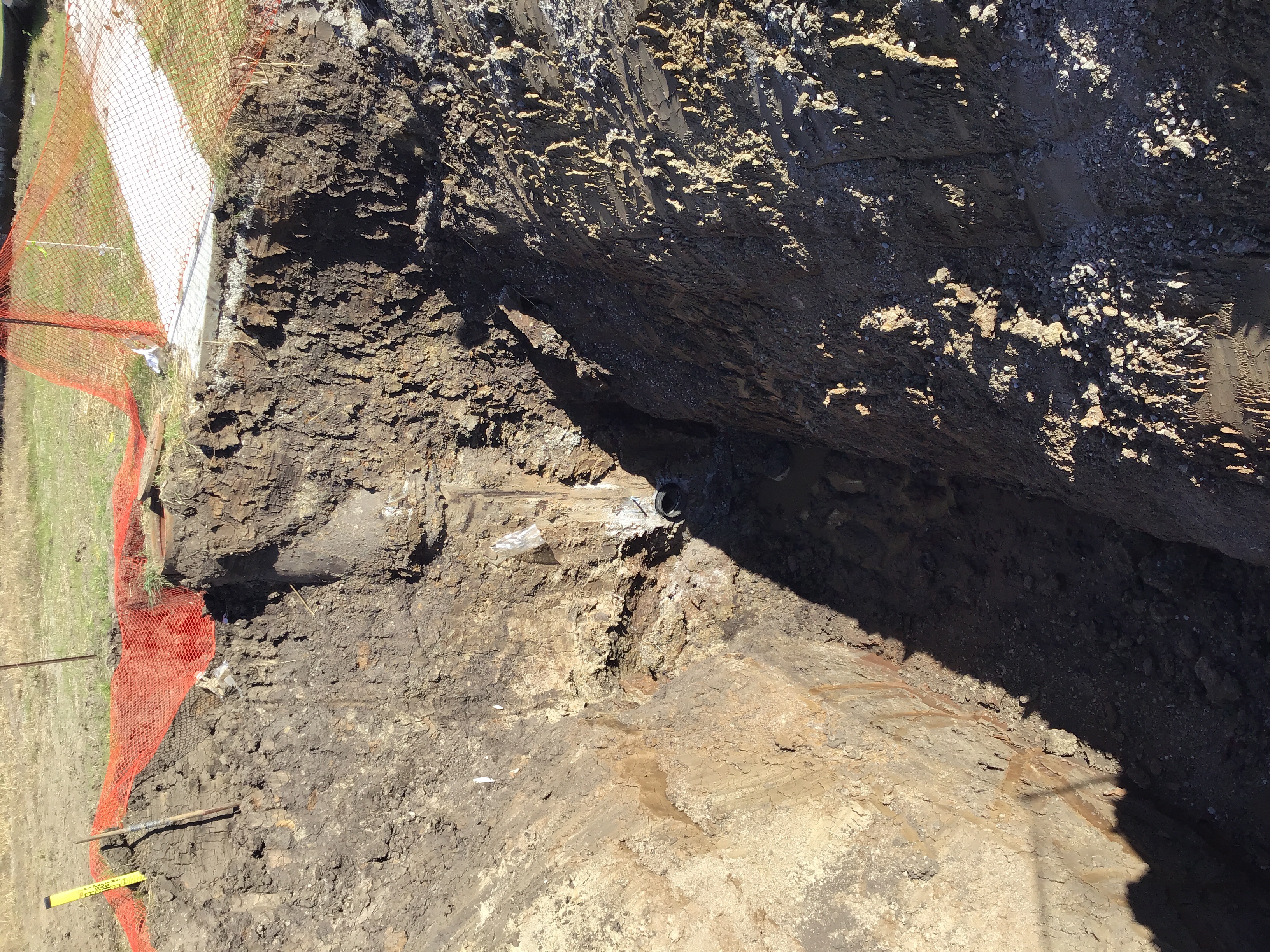

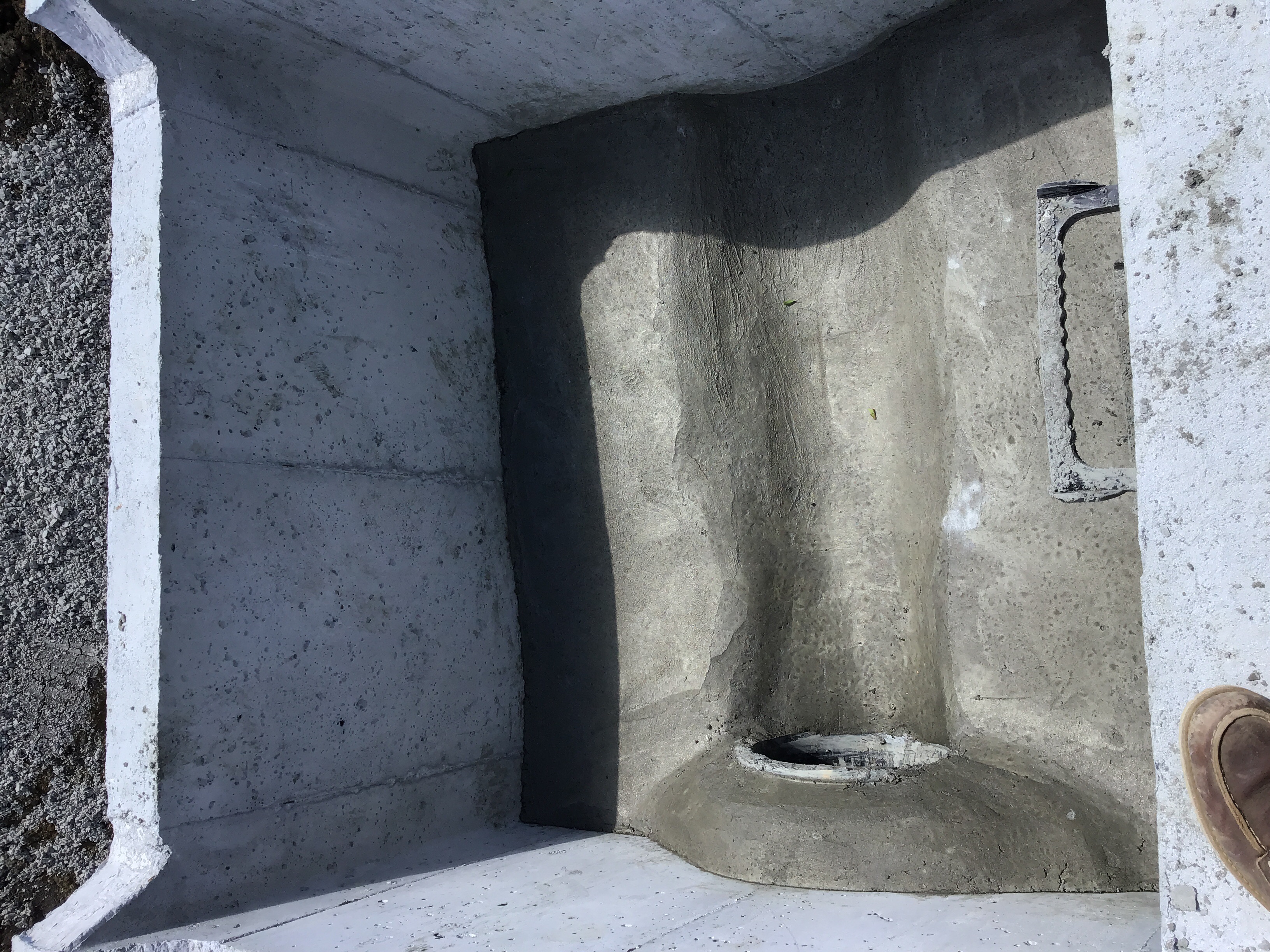

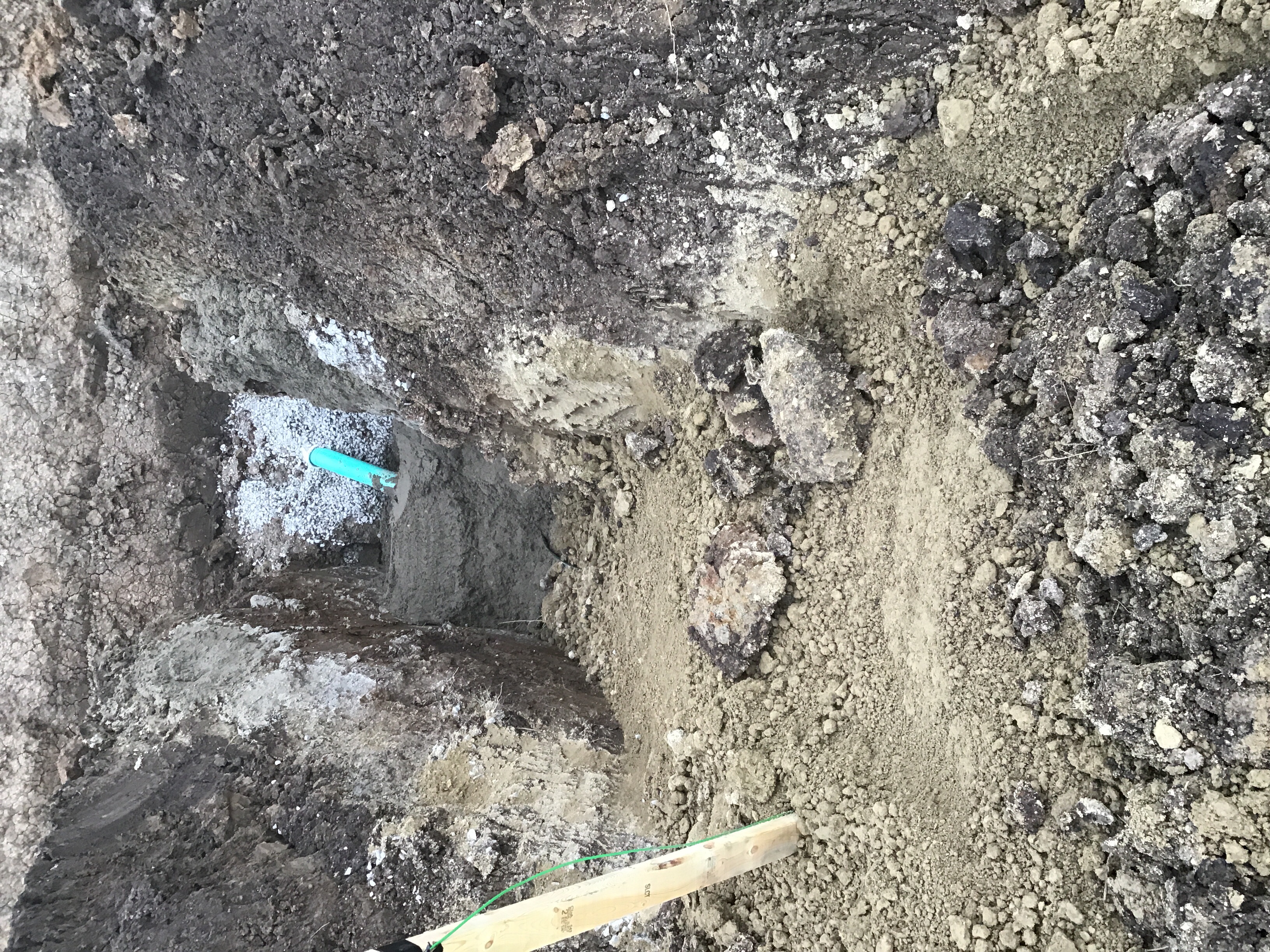

FAILED EROSION CONTROL INSPECTION There are numerous areas on site where the silt fence has failed and is allowing silt and mud to leave the site. Make corrections to the erosion control devices asap to control the silt from leaving the site.
Erosion Control Inspection Failed 04/23/2020
Miscellaneous Correction
Corrective Action Required
03/19/2020
FAILED EROSION CONTROL INSPECTION There are numerous areas on site where the silt fence has failed and is allowing silt and mud to leave the site. Make corrections to the erosion control devices asap to control the silt from leaving the site.
Misc
Corrective Action Required
04/23/2020
FAILED EROSION CONTROL The construction entrance needs to be re-established. Trucks moving in and out of the site are tracking mud all over the roads. Clean the mud from the roads.

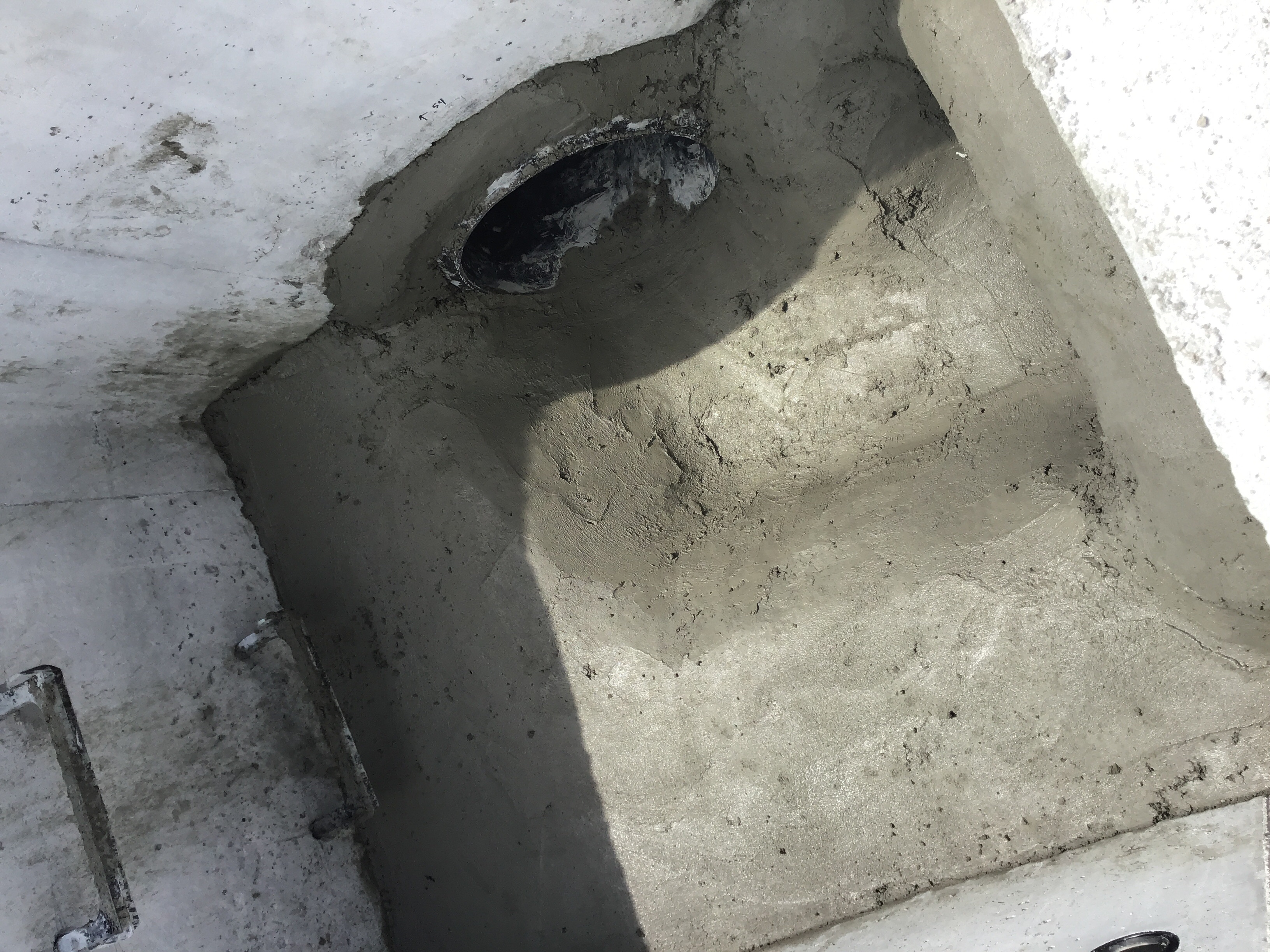

Sanitary Sewer Construction Inspection Passed 5/6/2020 05/13/2020
Misc
Informational
05/13/2020
The sanitary sewer lines for both The Manor & Reserve at Stoney Creek are installed. We will be testing the sewer lines in 30 days.
Erosion Control Inspection Failed 05/28/2020
Miscellaneous Correction
Resolved
05/28/2020
FAILED EROSION CONTROL INSPECTION There are numerous areas on site where the silt fence has failed and is allowing silt and mud to leave the site. Make corrections to the erosion control devices asap to control the silt from leaving the site.
Misc
Resolved
05/28/2020
FAILED EROSION CONTROL The construction entrance needs to be re-established. Trucks moving in and out of the site are tracking mud all over the roads. Clean the mud from the roads.
Misc
Corrective Action Required
05/28/2020
The construction entrances for both The Manor & Reserve at Stoney creek need to be re-established. Silt and mud is running off site and into the storm water collection system. Make corrections asap.

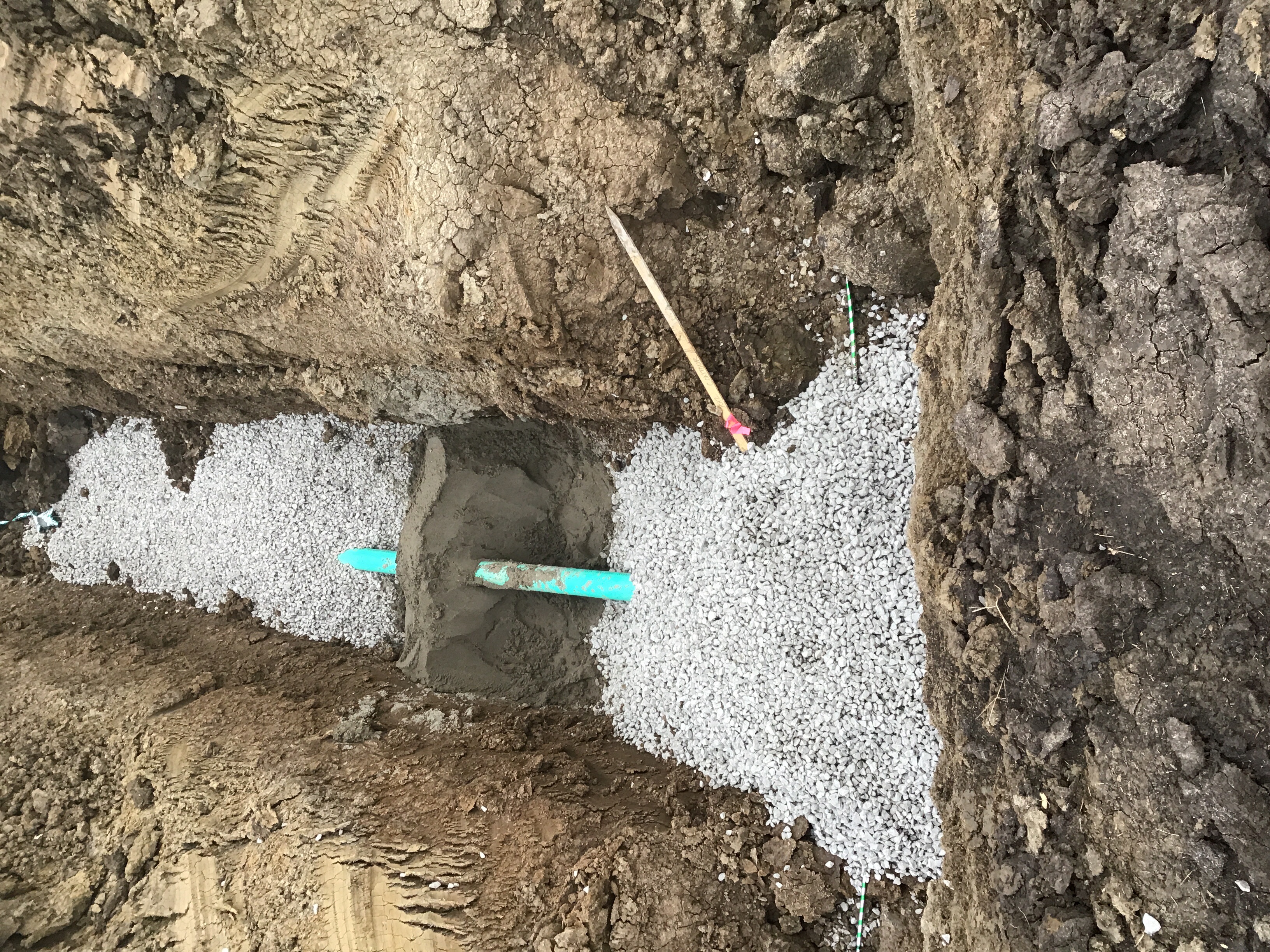

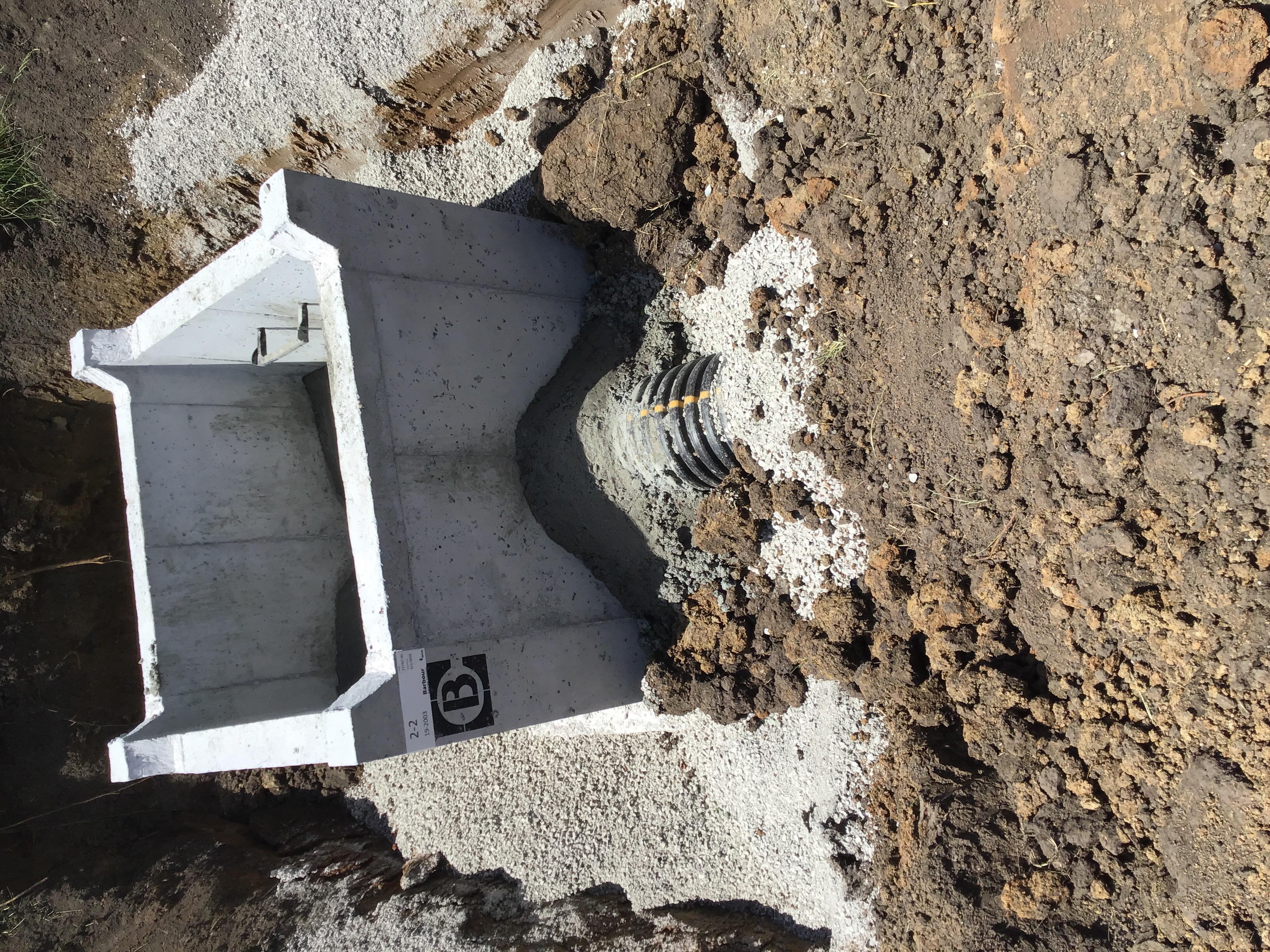

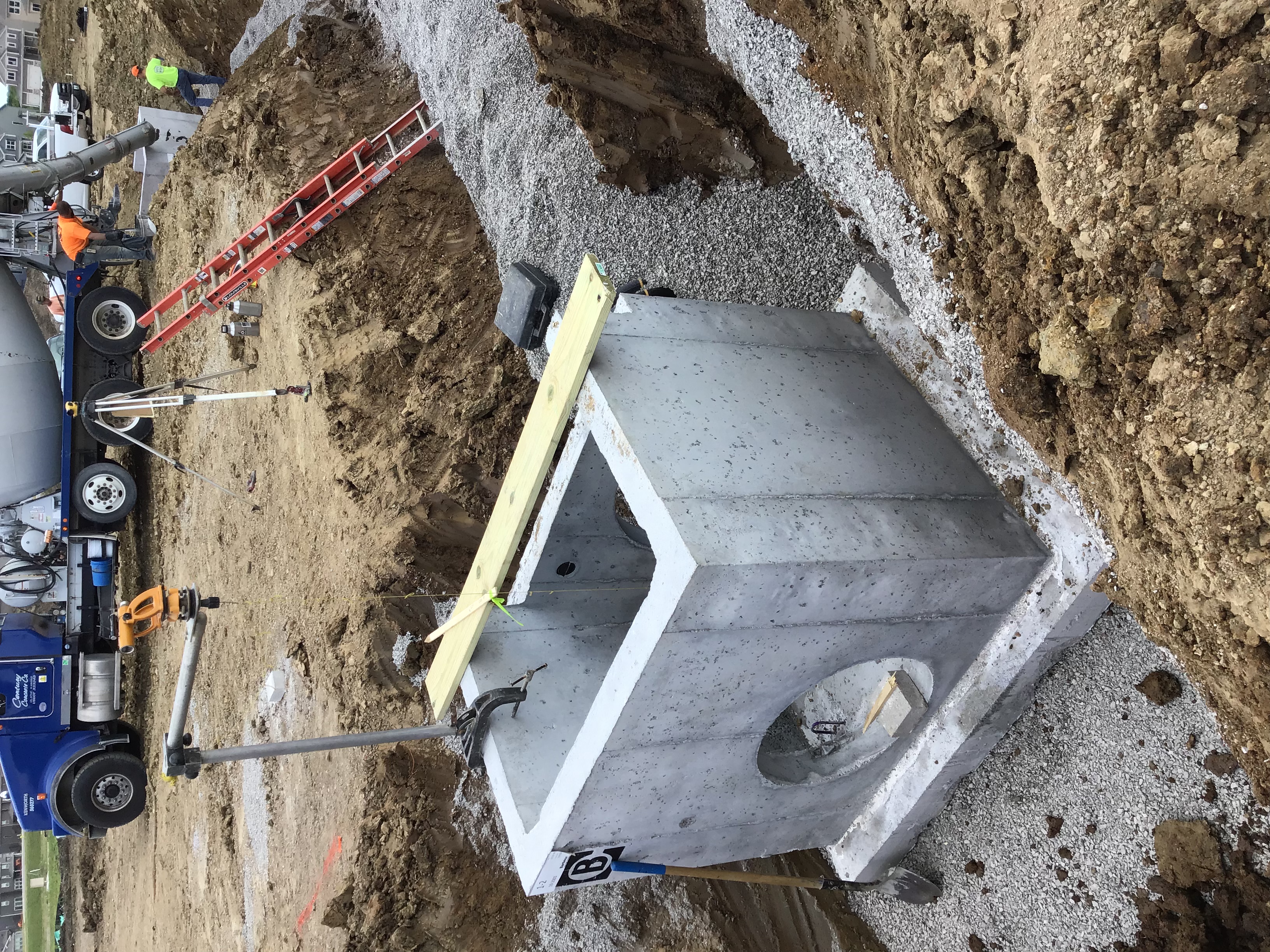

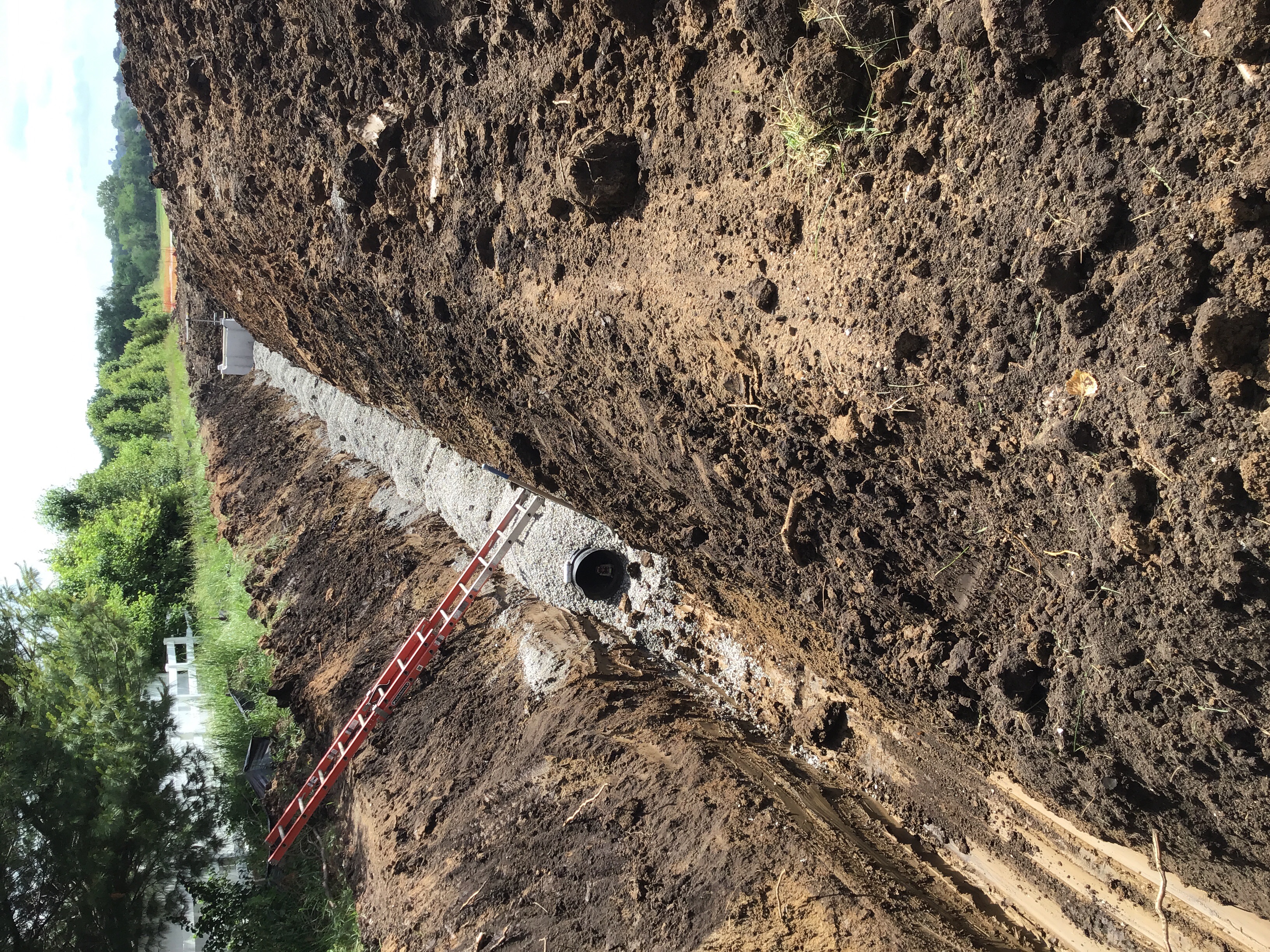

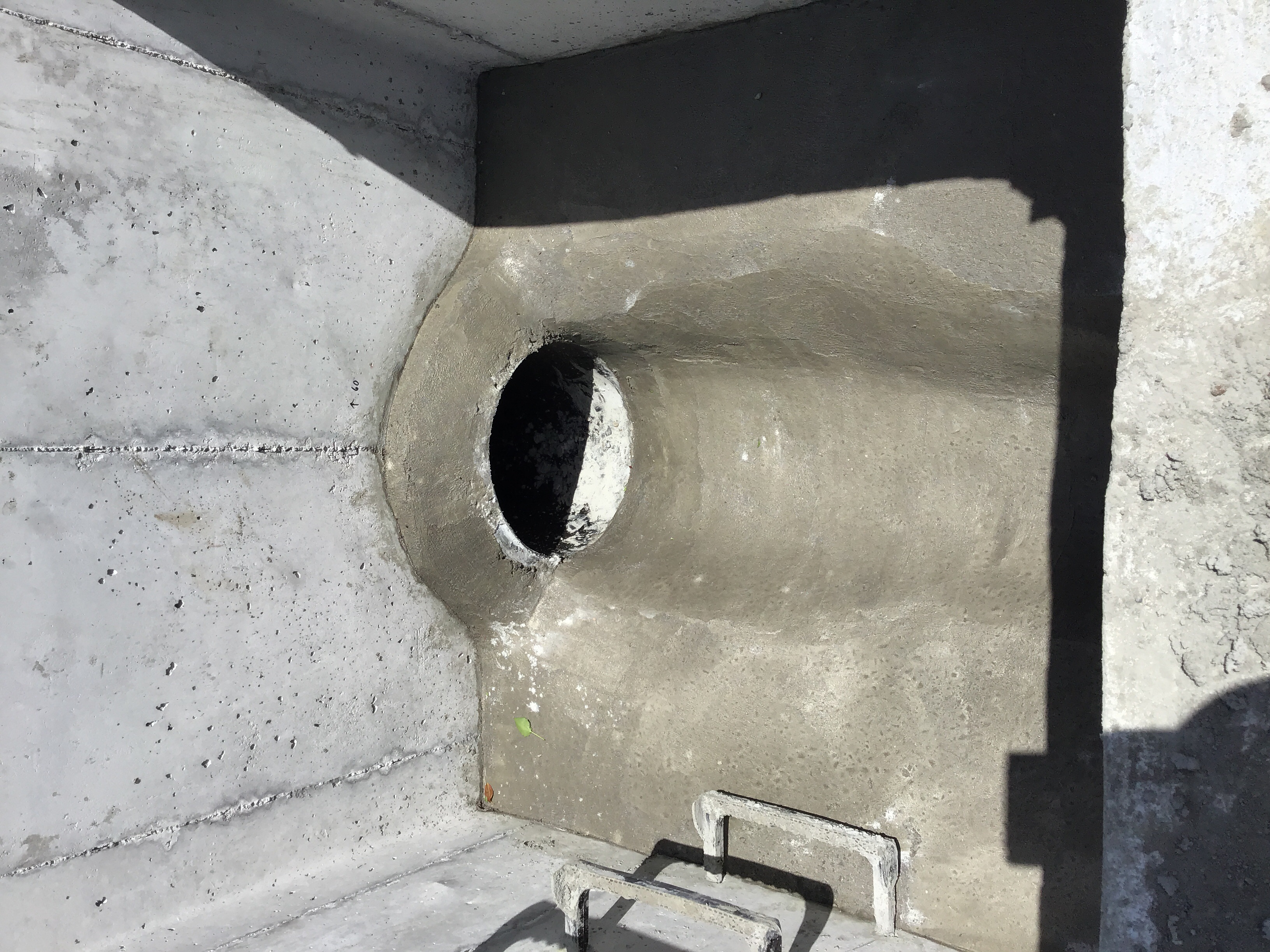

Storm Sewer Construction Inspection Partial 06/03/2020
Misc
Informational
06/03/2020

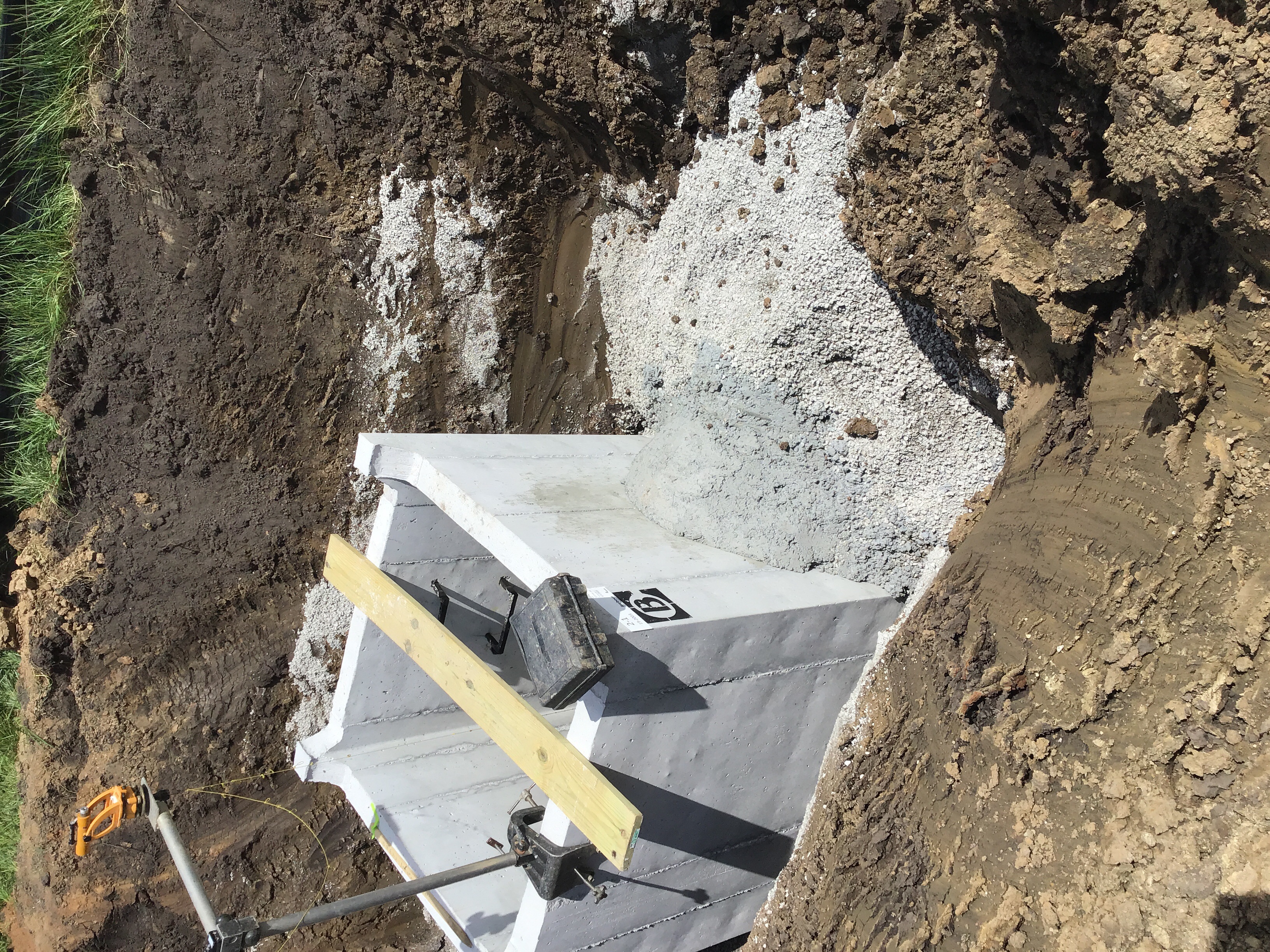

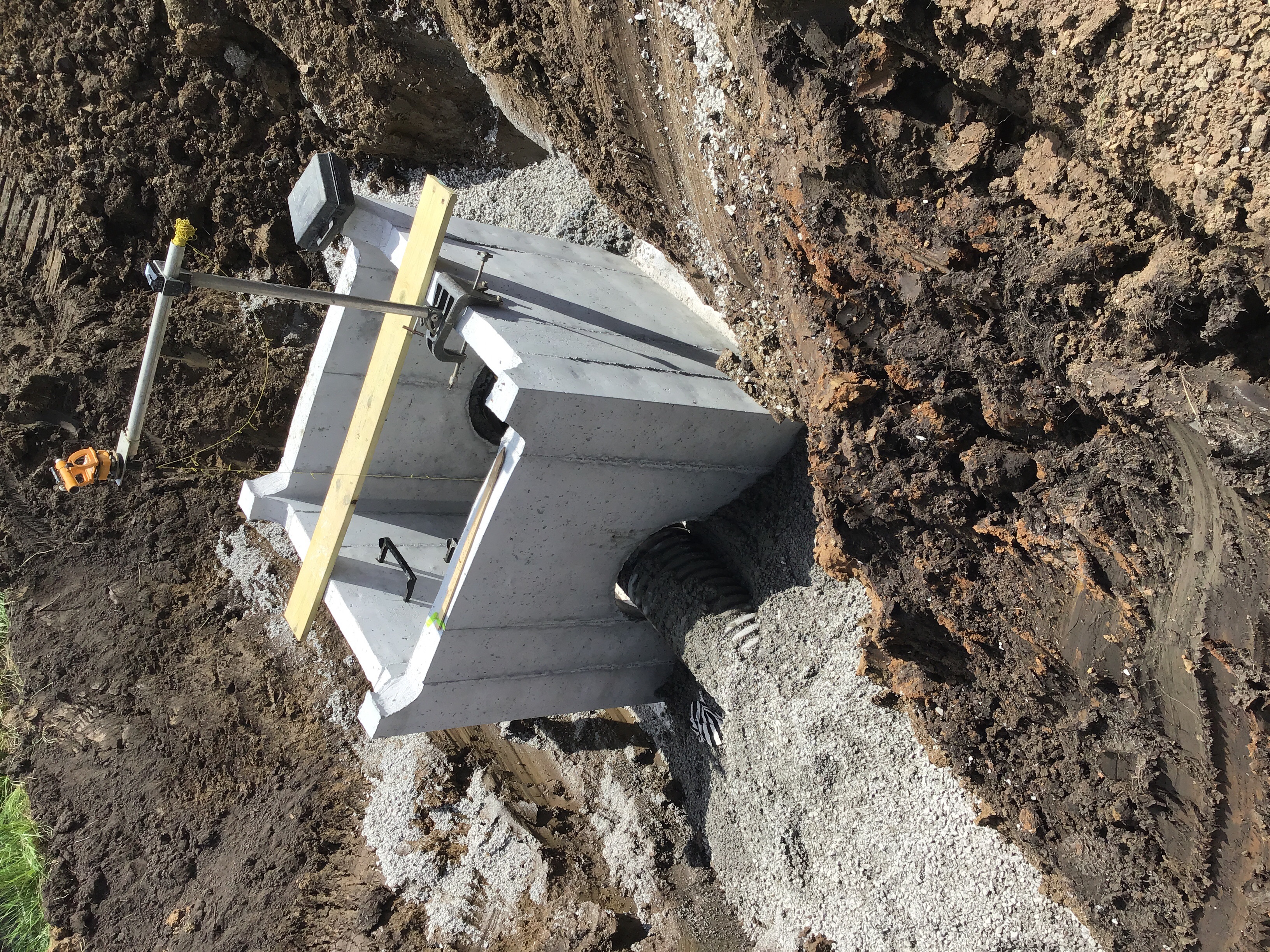

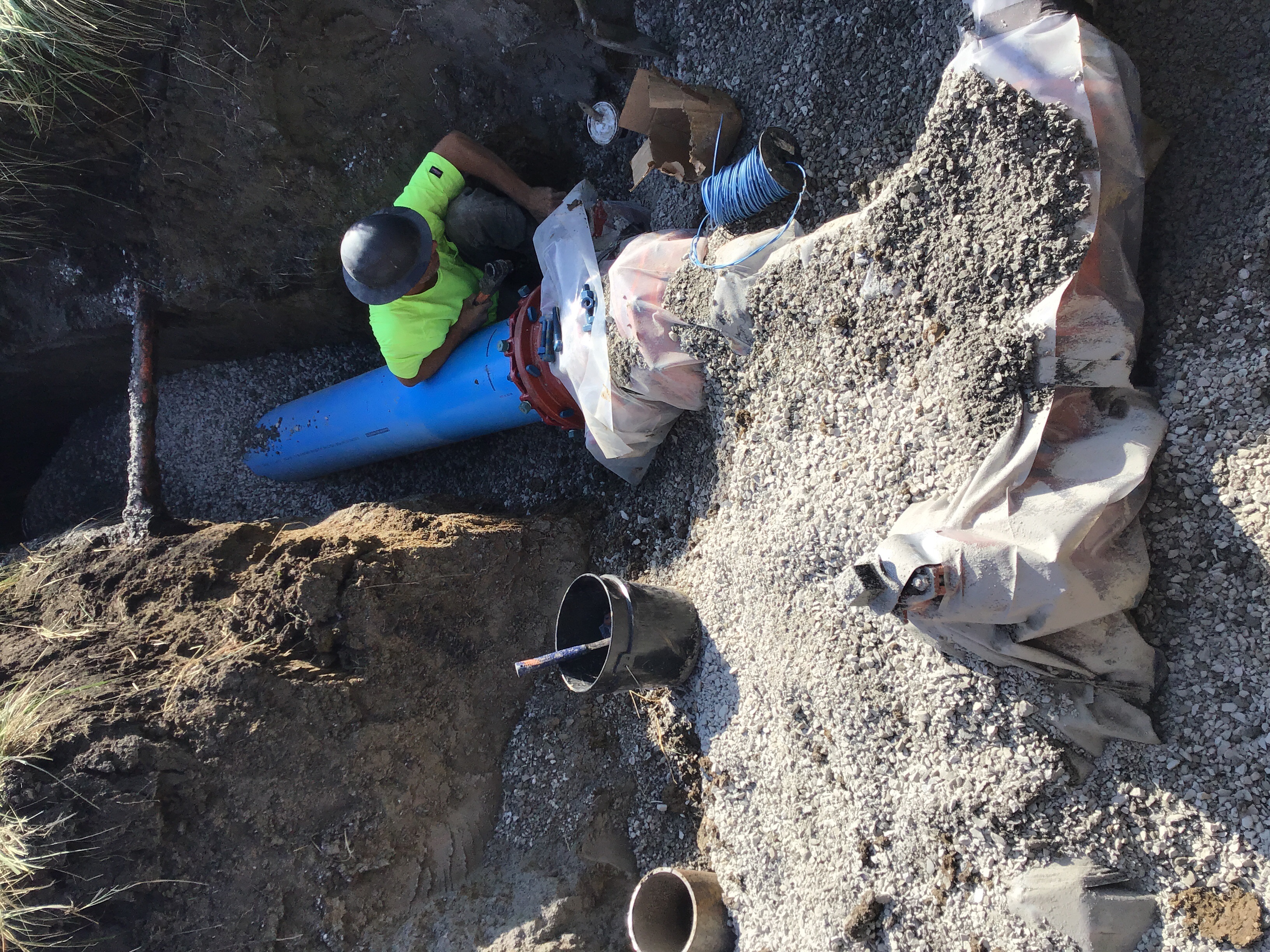

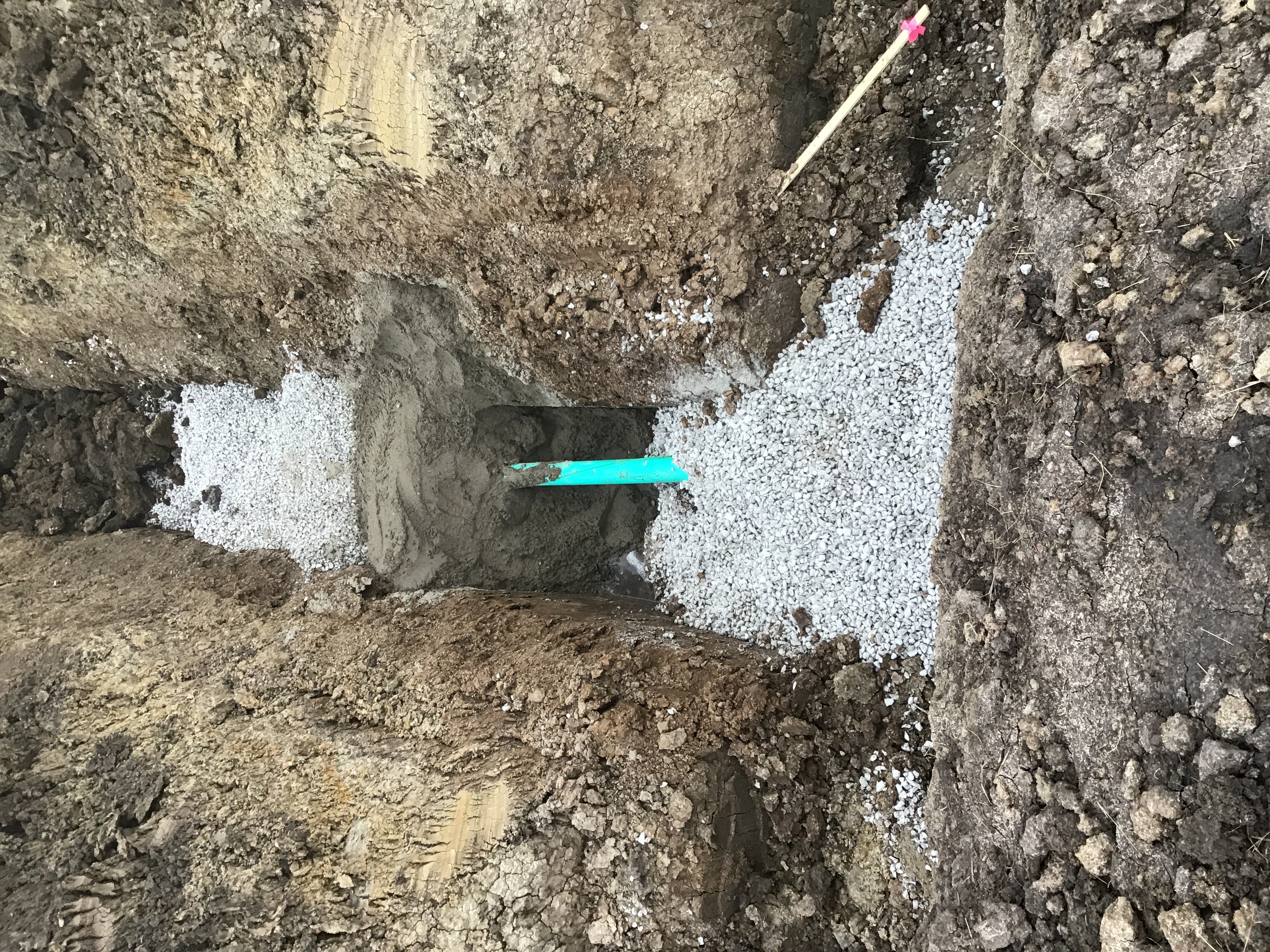

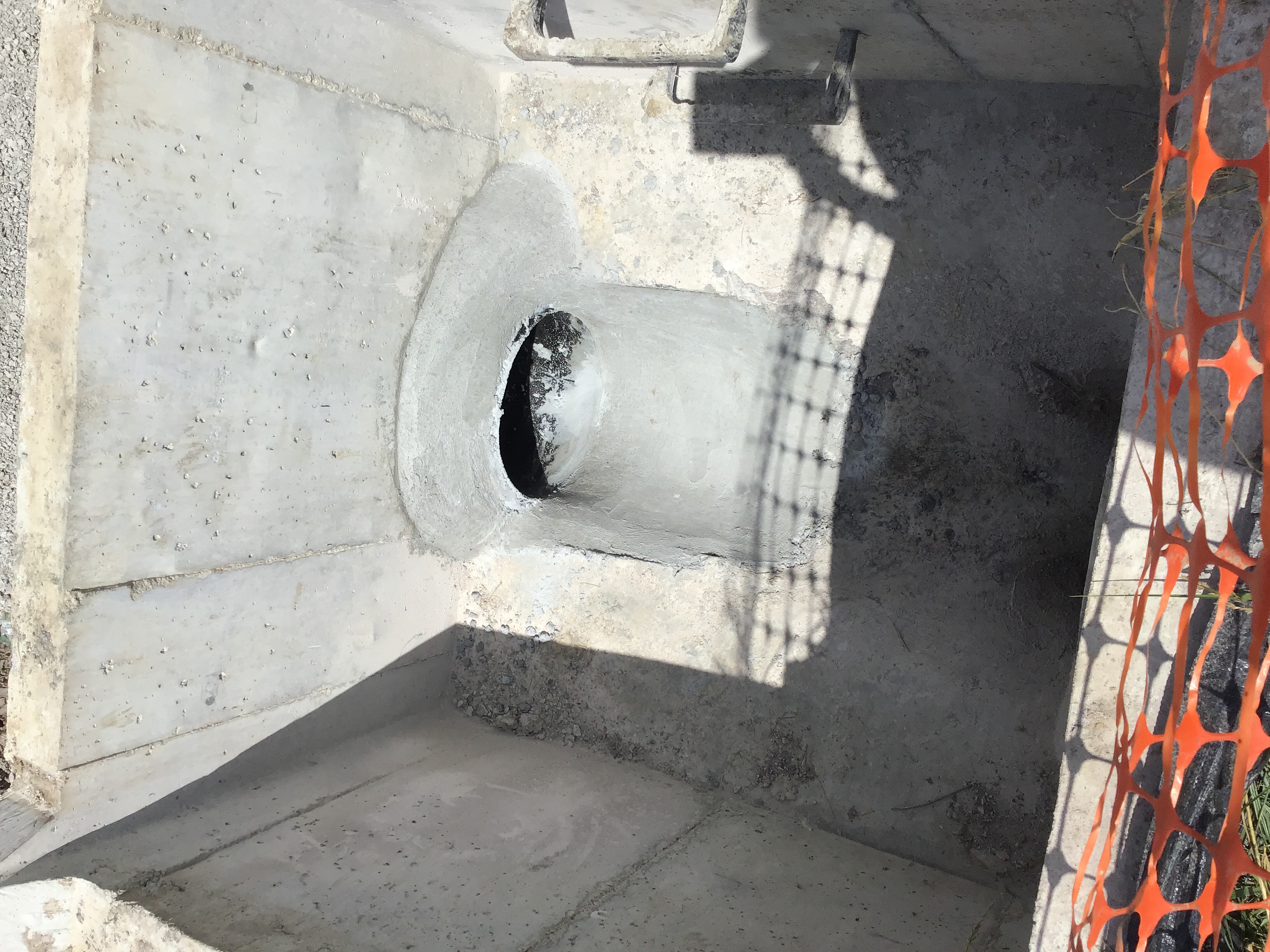

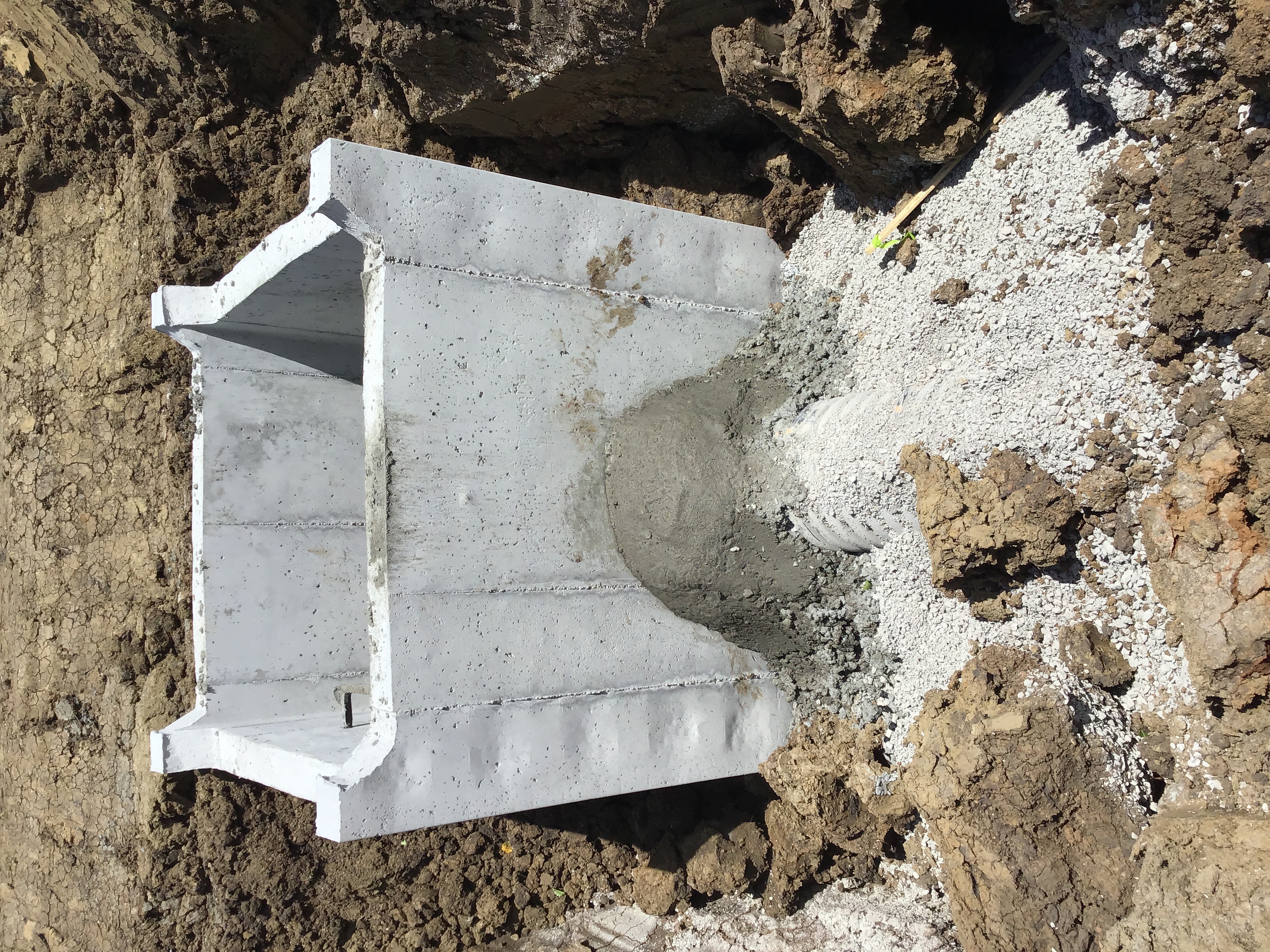

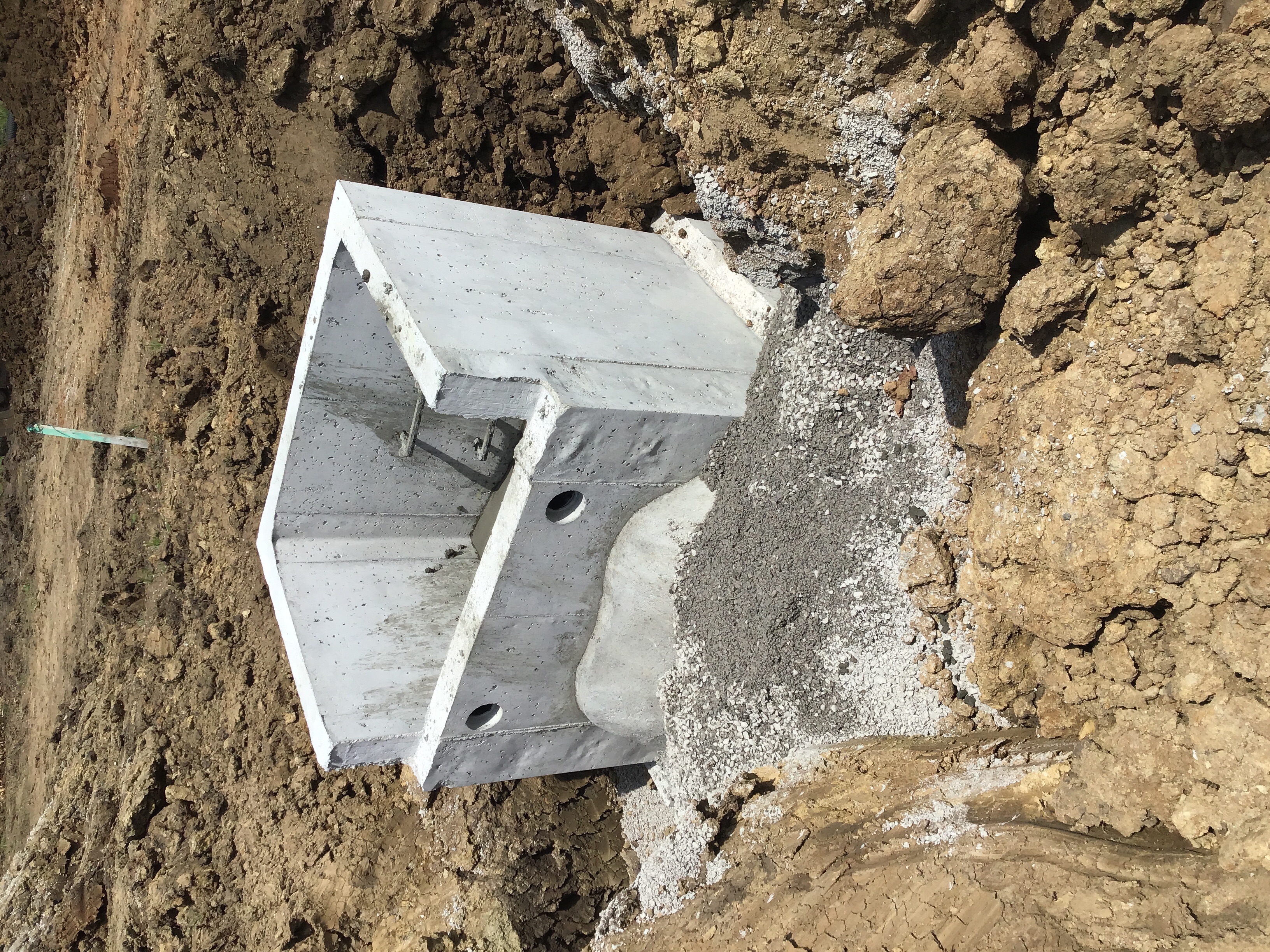

The Redford crew started the storm sewer install on line 1. The crew set storm boxes 1-1 & 1-2 and ran the HDPE pipe between the two boxes. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 6/4/2020 6/4/2020 06/09/2020
Misc
Informational
06/03/2020
The Redford crew started the storm sewer install on line 1. The crew set storm boxes 1-1 & 1-2 and ran the HDPE pipe between the two boxes. Photos of the work are uploaded.
Misc
Informational
06/09/2020
The Redford crew is working on both storm lines 1 & 2. Yesterday the crew set curb inlets 1-3 & 10-4, set the HDPE pipe between them and poured the collars. The crew is currently pouring the inverts for the two inlets. The crew has installed storm line 1 from the tie in at the existing field inlet 1-7 and has laid approximately 375’ ft of the 18” & 15” HDPE as well as set the FI 2-1. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 06/10/2020
Misc
Informational
06/09/2020
The Redford crew started the storm sewer install on line 1. The crew set storm boxes 1-1 & 1-2 and ran the HDPE pipe between the two boxes. Photos of the work are uploaded.
Misc
Informational
06/09/2020
The Redford crew is working on both storm lines 1 & 2. Yesterday the crew set curb inlets 1-3 & 10-4, set the HDPE pipe between them and poured the collars. The crew is currently pouring the inverts for the two inlets. The crew has installed storm line 1 from the tie in at the existing field inlet 1-7 and has laid approximately 375’ ft of the 18” & 15” HDPE as well as set the FI 2-1. Photos of the work are uploaded.
Misc
Informational
06/10/2020
The Redford crew installed the collars and inverts for the remainder of storm line 2. The line has been back filled and the crew plans to set the inlet lids after the concrete cures.

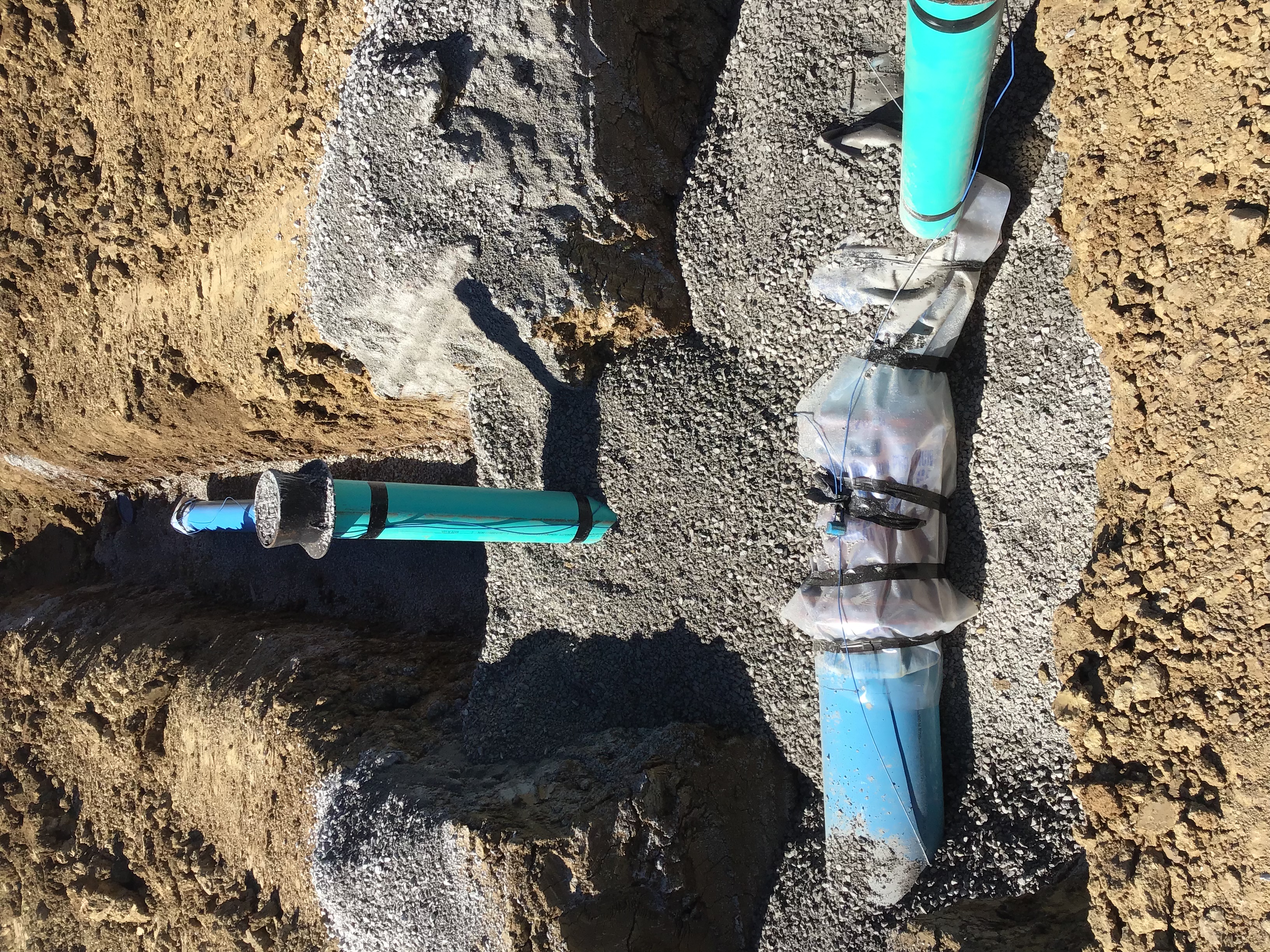

Water Line - Construction Inspection Partial 06/10/2020
Misc
Informational
06/10/2020

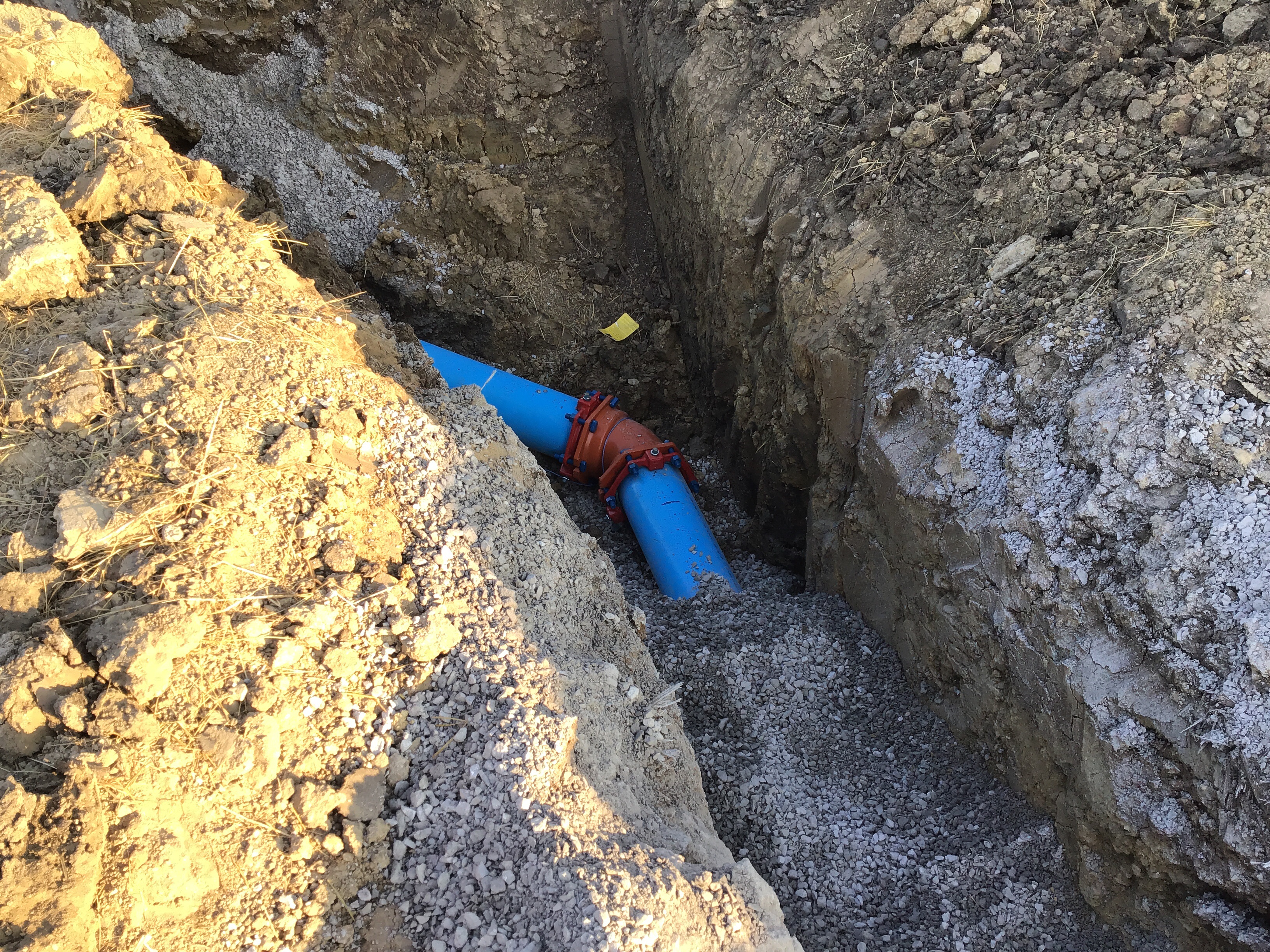

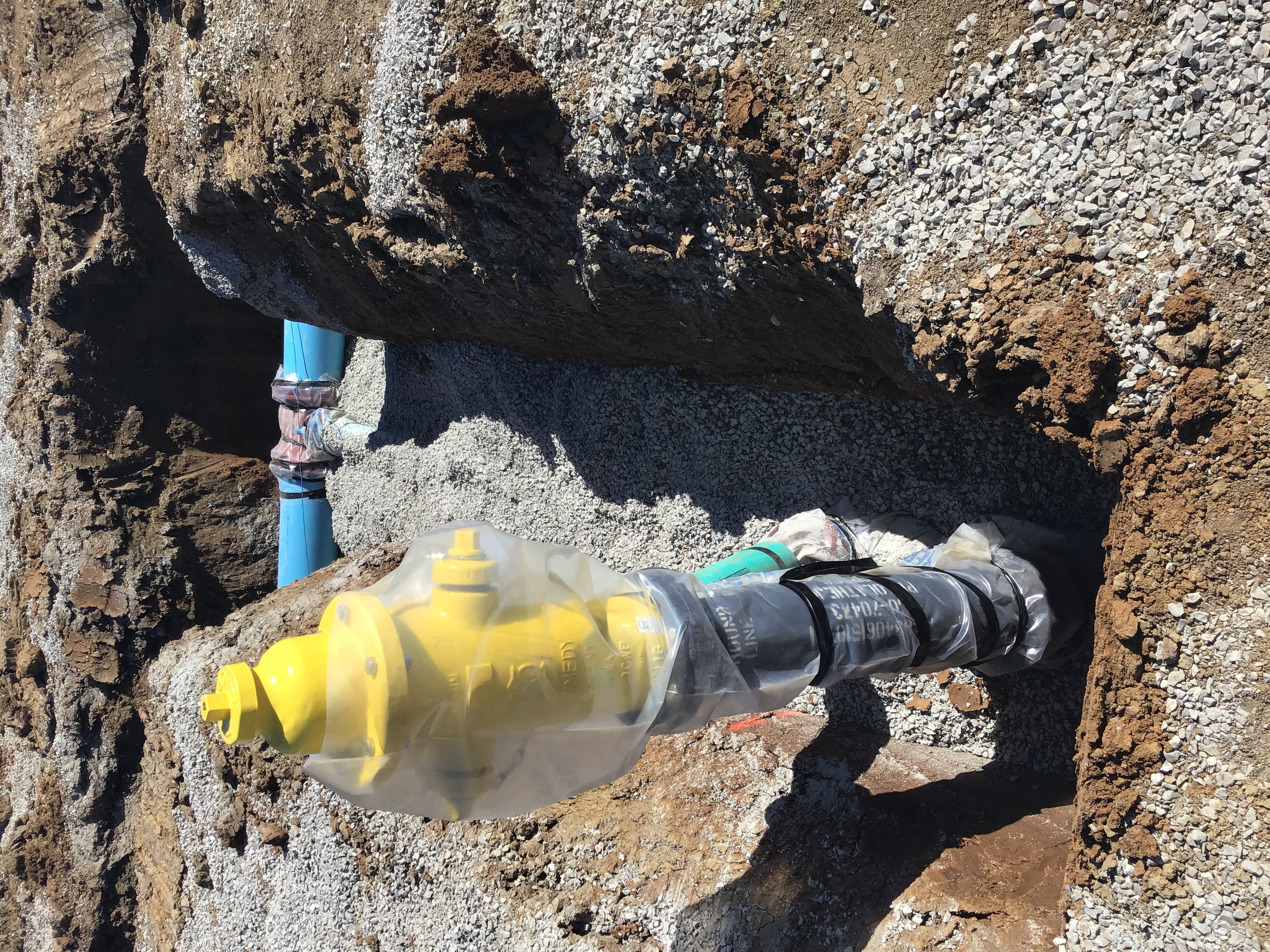

The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Water Line - Construction Inspection Partial 06/11/2020
Misc
Informational
06/11/2020

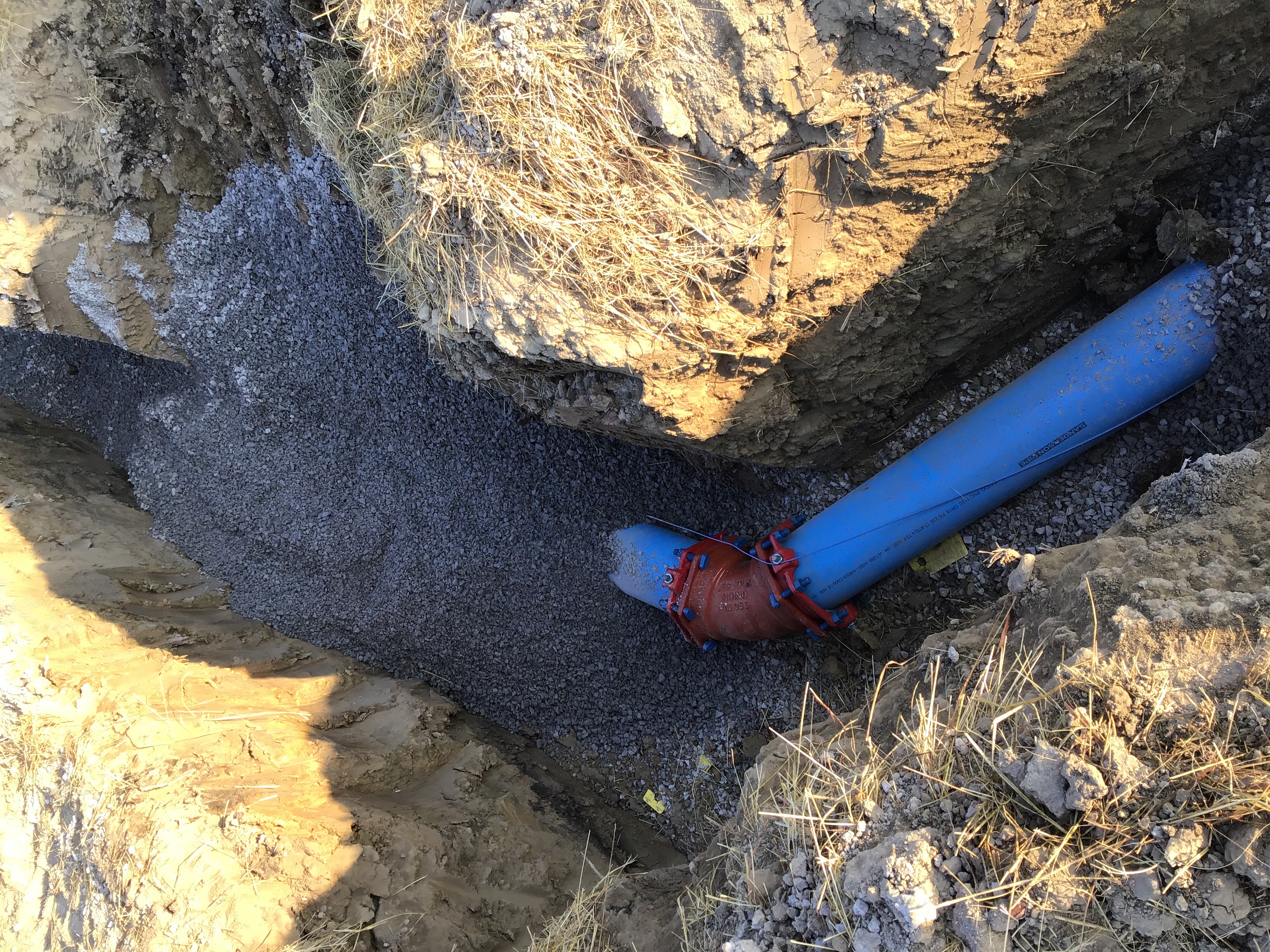

The Redford crew is continuing the water line 2 install. The crew has the line set from approx station 1019.00 to 3+00. They installed the 12” x 8” tee and butterfly valve. The crew also installed the 11.25 fitting just beyond that. The crew plans to pour thrust blocks this afternoon. Photos have been uploaded and I return for further inspection this afternoon.
Water Line - Construction Inspection Partial 06/11/2020
Misc
Informational
06/11/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
06/11/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.

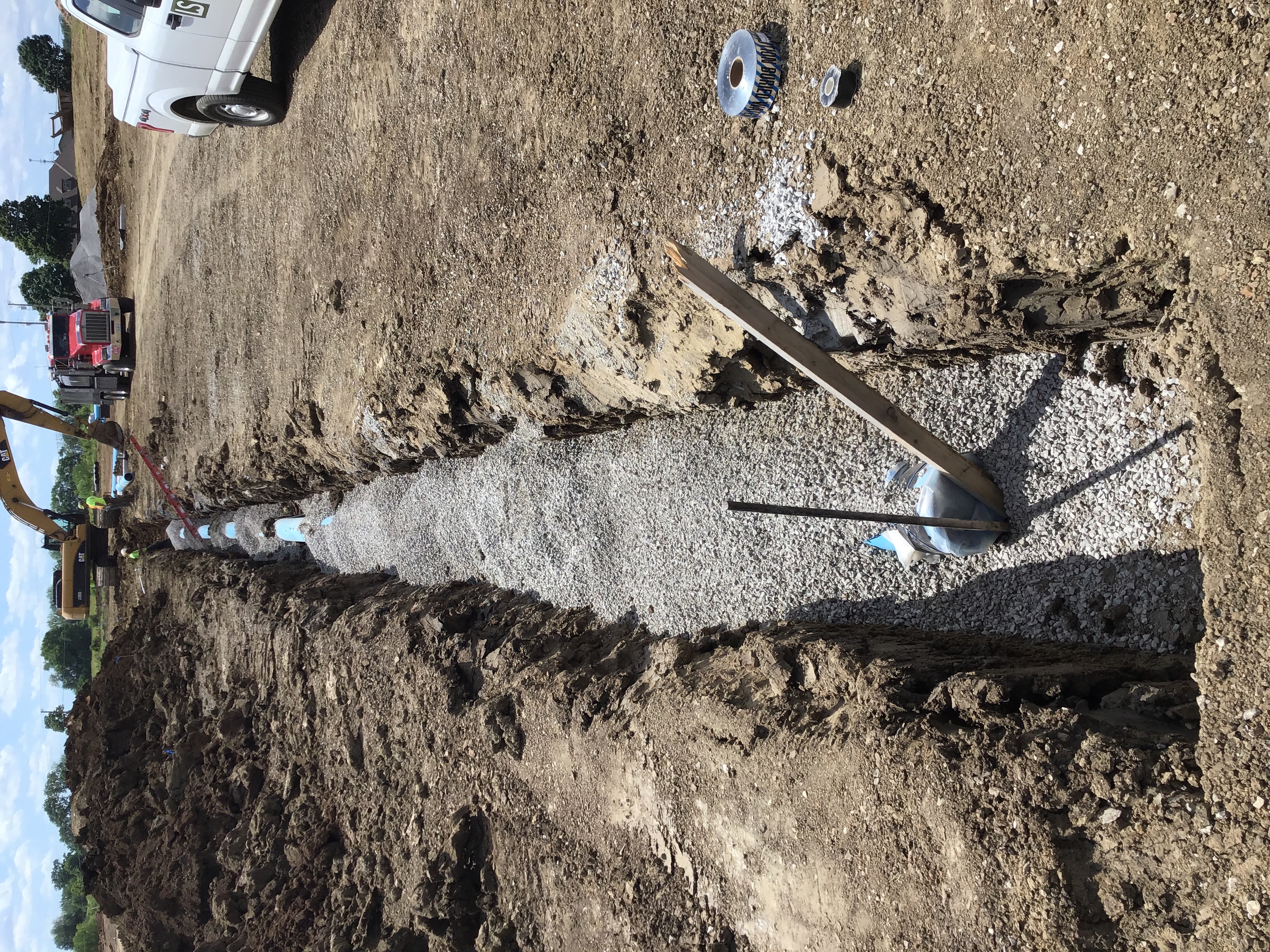

Sanitary Sewer - Air Test Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 3:18 PM I observed the sanitary sewer air test for Line 1 and the results are as follows: Line 1 segment between MH 1-3 & 1-4 Line held at 4psi for 9:00 with no drop Test Passed Line 1 segment between MH 1-4 & 1-5 Line held at 4psi for 7:34 with no drop Test Passed
Sanitary Sewer - Mandrel Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 3:22 PM I observed the mandrel test for Sanitary line 1 and verified that the mandrel meets the City of LS Design and Construction Manual requirements. The mandrel pulled through the line with no deflection. Test Passed
Sanitary Sewer - Vacuum Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 3:25 PM I observed the vacuum test for the manholes on sanitary line 1 and the results are as follows: MH 1-4 less than 10'ft deep Gauge held at 10 for 2 minutes with no drop Test Passed MH 1-5 less than 10'ft deep Gauge held at 10 for 2 minutes with no drop Test Passed
Pavement-Stabilized Subgrade Passed 07/22/2020
Misc
Informational
07/22/2020
On Friday 7/17/2020 Steve Robbins was on site while Spalding Excavating installed the 4% Portland Cement sub grade for stabilization. He stated that the means and methods used for the install were in compliance. KC Testing was on site during the install for compaction testing and has provided us with the results.
Pavement-Proof Roll Failed 07/23/2020
Misc
Corrective Action Required
07/23/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. There were a number of areas with deflection. The sub grade still needs more time to cure out.
Pavement-Proof Roll Partial 07/24/2020
Misc
Informational
07/24/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. The roll test passed with no deflection. The crew plans to install the base rock layer next week.
Site Visit Partial 07/29/2020
Misc
Informational
07/29/2020
JK Concrete is on site installing the curb stakes ahead of the curb going in. The roads still need a passing sub grade proof roll prior to curb going in.
Pavement-Proof Roll Passed 08/04/2020
Misc
Corrective Action Required
07/24/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. There were a number of areas with deflection. The sub grade still needs more time to cure out.
Misc
Informational
08/04/2020
John DiMauro 8/4/2020 After the heavy rain event over the weekend, another proof roll was required. I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. The roll test passed with no deflection. The crew plans to install the base rock layer next week.

Curb - Proof Roll Passed 08/13/2020
Misc
Informational
08/13/2020
I observed the proof roll of the aggregate base for the curbs. I verified the correct load weight and the roll test passed with no deflection.
Public Curb Inspection Partial 08/19/2020
Misc
Informational
08/19/2020
John DiMauro 8/19/2020 9:30 AM JK Concrete is on site installing the public curbs. I have verified the correct concrete mix being used. The practices being used comply. KC Testing lab is on site pulling concrete samples every 50 cubic yards. We will be provided with the testing results.
Public Curb Inspection Partial 08/20/2020
Misc
Informational
08/19/2020
John DiMauro 8/19/2020 9:30 AM JK Concrete is on site installing the public curbs. I have verified the correct concrete mix being used. The practices being used comply. KC Testing lab is on site pulling concrete samples every 50 cubic yards. We will be provided with the testing results.
Misc
Informational
08/20/2020

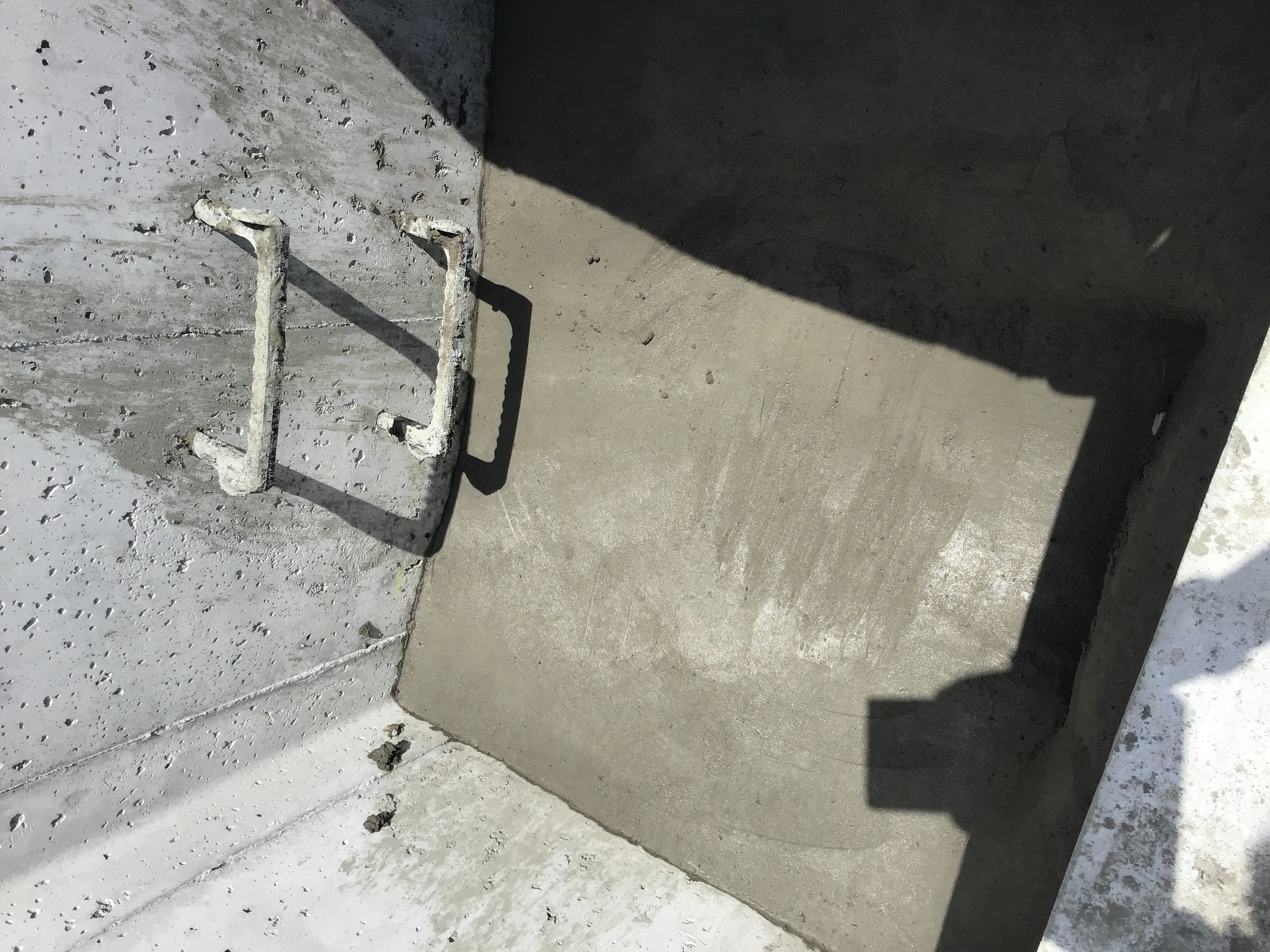

John DiMauro 8/20/2020 10:21 AM The JK Concrete crew poured the public road curbs yesterday and is on site pouring the curb inlet throats today. I am on site verifying the correct concrete mix type and the methods used for the install. Photos are uploaded.
Pavement-Proof Roll Passed 08/25/2020
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 8:25 AM Yesterday 8/24/2020 I observed the proof roll test of the aggregate sub-grade. The roll test passed with no deflection. Superior Bowen plans to pave the base and surface layers starting tomorrow.
Sanitary Sewer Construction Inspection Partial 08/25/2020
Misc
Resolved
08/25/2020
The Redford crew completed the line 1 run to MH 1-5. All the service laterals are installed and the crew plans to pour the trench checks later today. I will return for further inspection of the trench checks and service laterals tomorrow morning prior to back filling and will upload photos of the construction at that time.
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 2:25 pm Redford Construction is on site making corrections to the SS manholes that were called out by Water Utilities camera inspection. I will take photos of the work once its complete.
Pavement-Surface Passed 8/27/2020 8/27/2020 08/27/2020
Misc
Informational
08/27/2020
John DiMauro 8/27/2020 Yesterday 8/26 Superior Bowen was on site and installed the base lift for the subdivision roads. I verified the correct mix type was used and the temperatures and methods used for the install were in compliance.
Street - Surface Course Passed 08/27/2020
Misc
Informational
08/27/2020
John DiMauro 8/27/2020 2:20 PM I was on site today and observed the install of the roadway surface asphalt lift. The Superior Bowen crew installed the asphalt and the mix type, asphalt temp and methods used for the install were in compliance.
Erosion Control Inspection Failed 08/31/2020
Misc
Resolved
08/31/2020
The construction entrances for both The Manor & Reserve at Stoney creek need to be re-established. Silt and mud is running off site and into the storm water collection system. Make corrections asap.
Misc
Corrective Action Required
08/31/2020
John DiMauro 8/31/2020 8:25 AM EROSION CONTROL INSPECTION Install erosion control devices on site according to the ESC PHASE 2 SHEET C.051 Take additional ESC measures that are not called out on the plans in the low lying areas that will allow for silt and sediment to leave the site. Make these corrections asap.

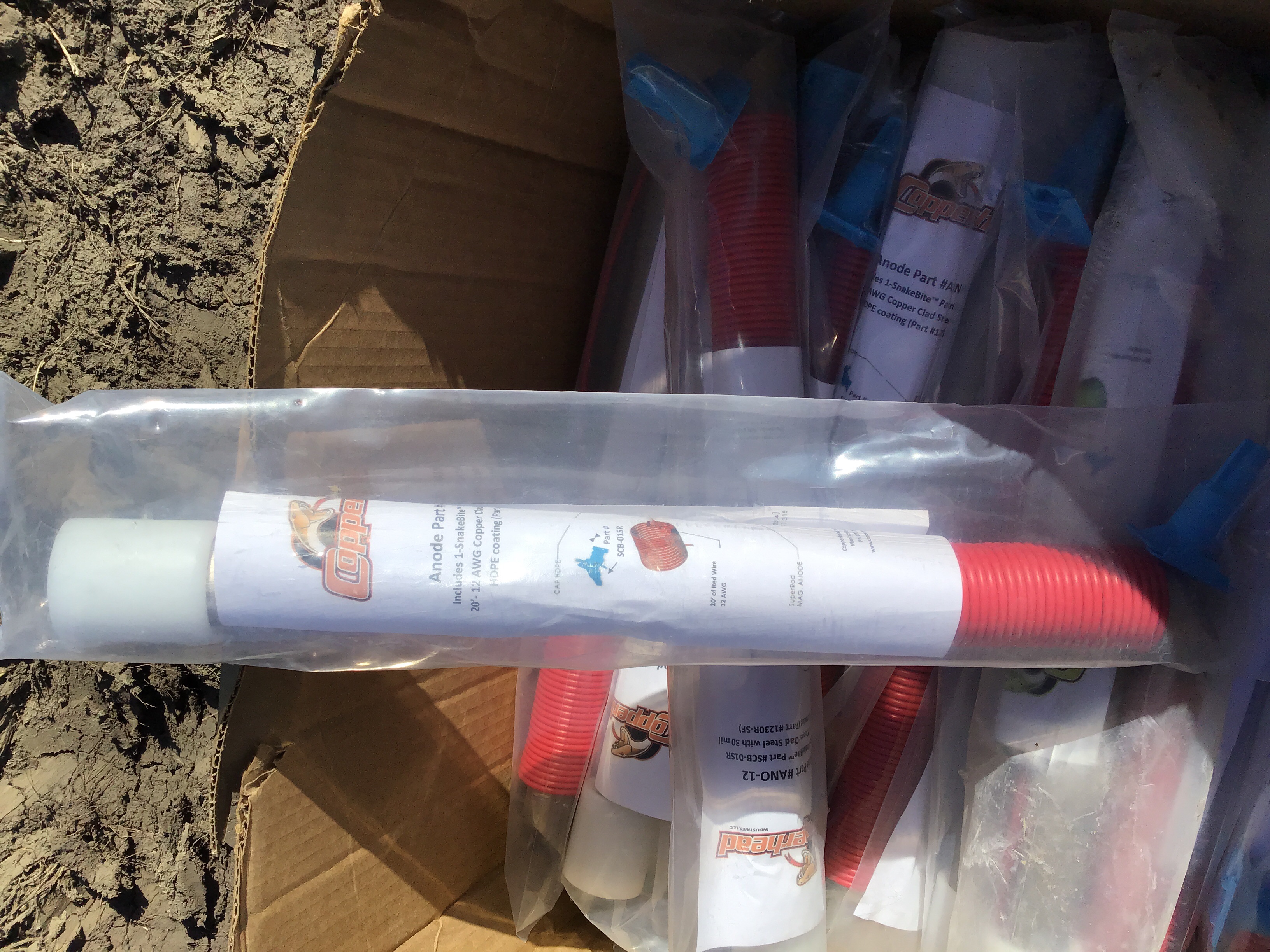

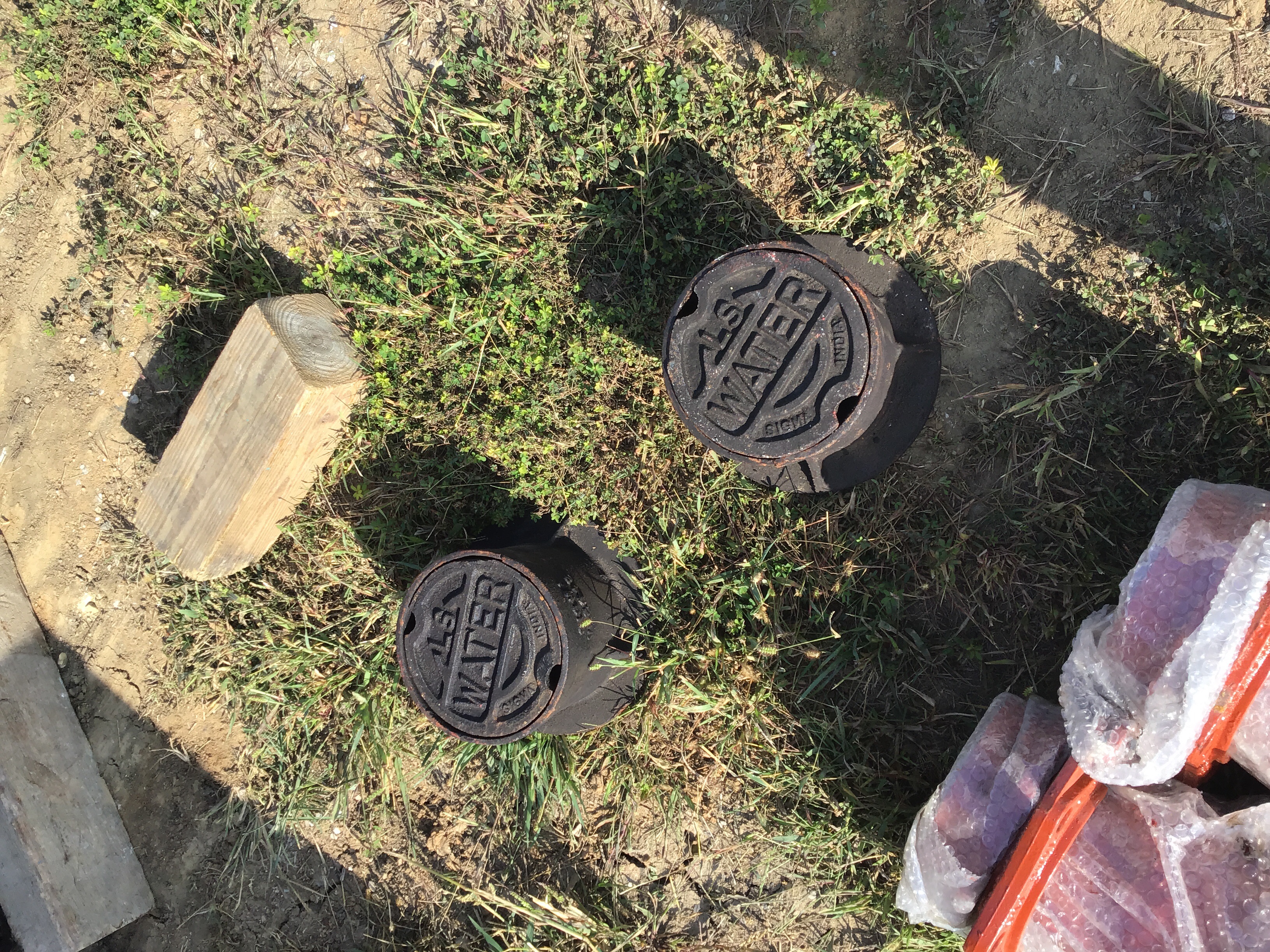

Water - Material Verification Passed 09/24/2020
Misc
Informational
09/24/2020
John DiMauro 9/24/2020 10:20 AM Materials verified. Photos uploaded.
Water Line - Construction Inspection Partial 09/24/2020
Misc
Informational
06/11/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
06/11/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
09/24/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Water Line - Construction Inspection Partial 09/25/2020
Misc
Informational
09/24/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
09/24/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
09/24/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
09/25/2020

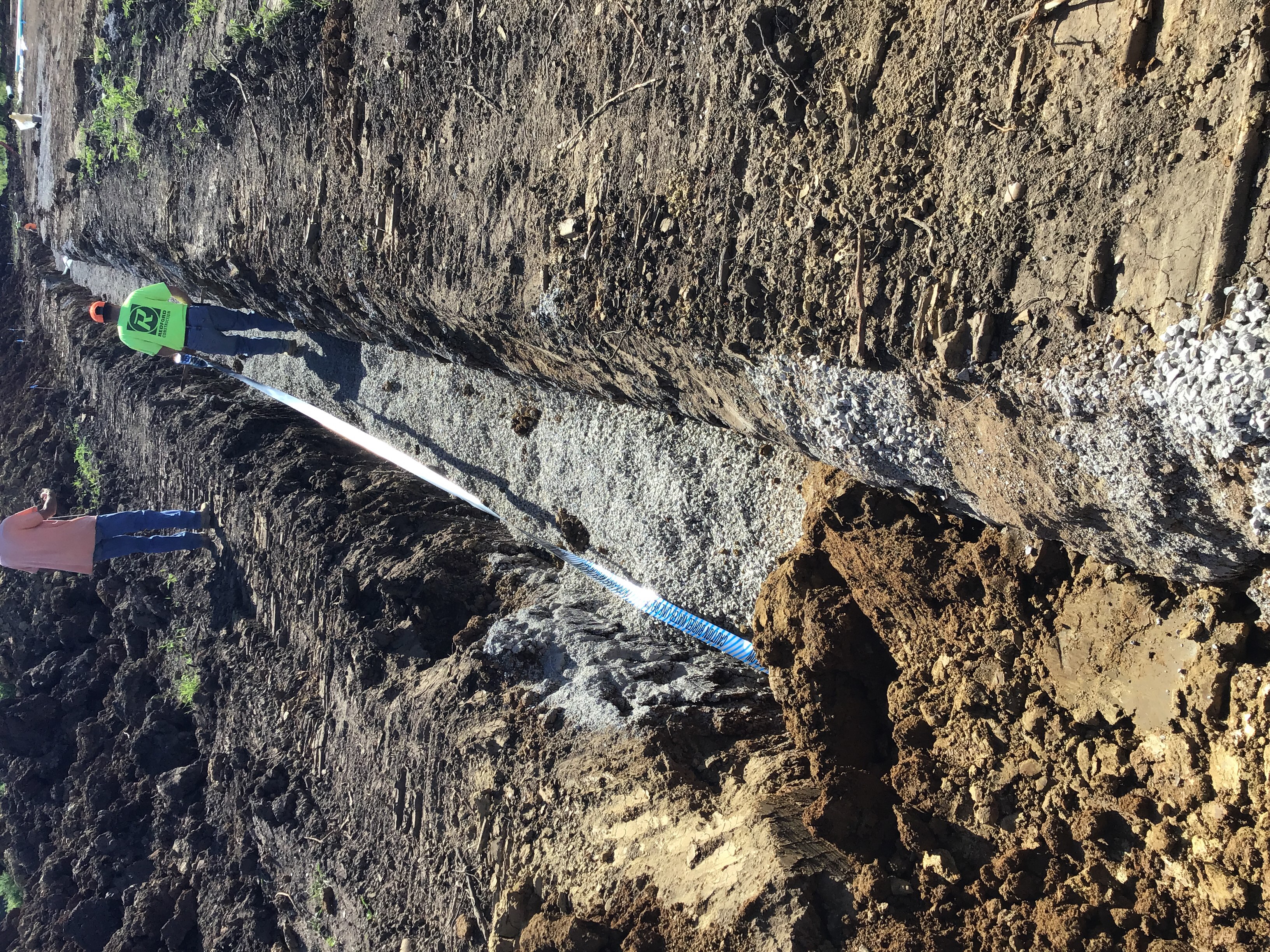

John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Water Line - Construction Inspection Partial 09/29/2020
Misc
Informational
09/25/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
09/25/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
09/25/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
09/25/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
09/29/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Water Line - Construction Inspection Partial 10/06/2020
Misc
Informational
09/29/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
09/29/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
09/29/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
09/29/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
09/29/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Misc
Informational
10/06/2020
John DiMauro 10/6/2020 11:23 AM The Redford crew is working on the water main tie in alone SW Pryor RD. Ive been on site during the install to assist with shutting the water off and on all morning. The crew is currently tied into the existing main and setting pipe under the road. The water is restored at this time. Photos are uploaded.
Water Line - Construction Inspection Partial 10/07/2020
Misc
Informational
10/06/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
10/06/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
10/06/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
10/06/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
10/06/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Misc
Informational
10/06/2020
John DiMauro 10/6/2020 11:23 AM The Redford crew is working on the water main tie in alone SW Pryor RD. Ive been on site during the install to assist with shutting the water off and on all morning. The crew is currently tied into the existing main and setting pipe under the road. The water is restored at this time. Photos are uploaded.
Misc
Informational
10/07/2020

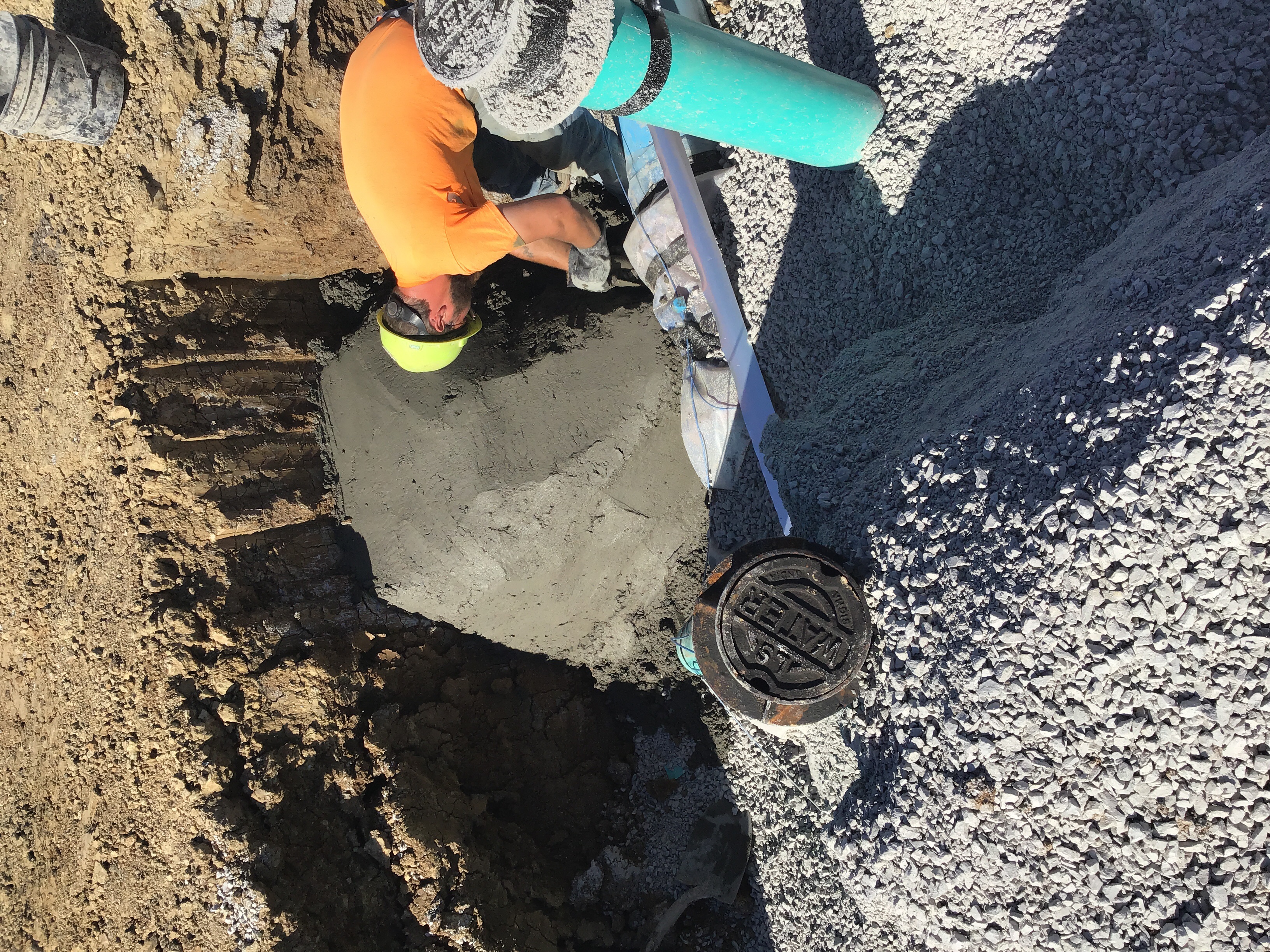

John DiMauro 10/7/2020 8:50 AM The Redford crew poured the thrust block for the tie in assembly on SW Pryor RD. The crew also poured the concrete road patch for the water line trench. Photos are uploaded.

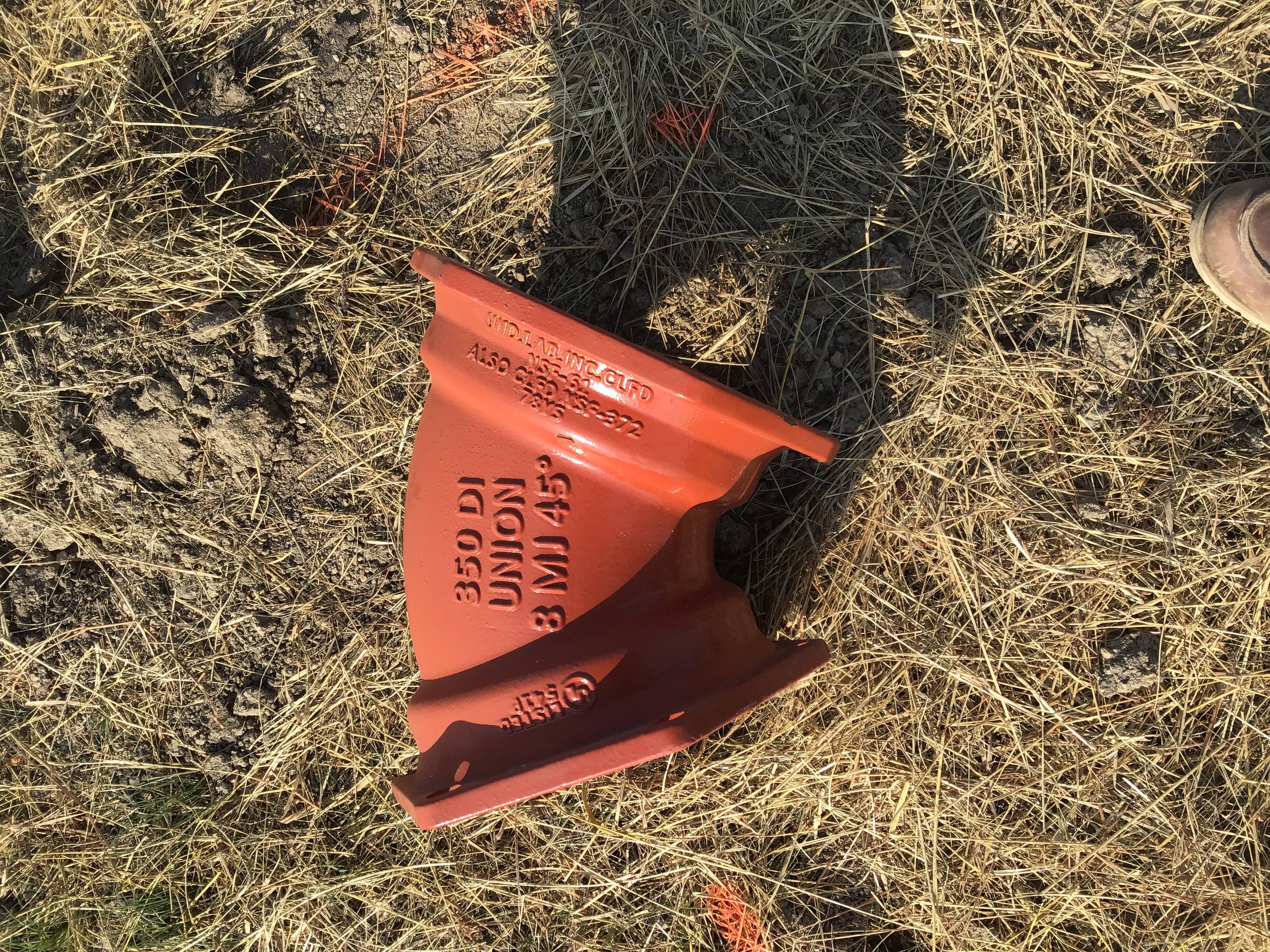

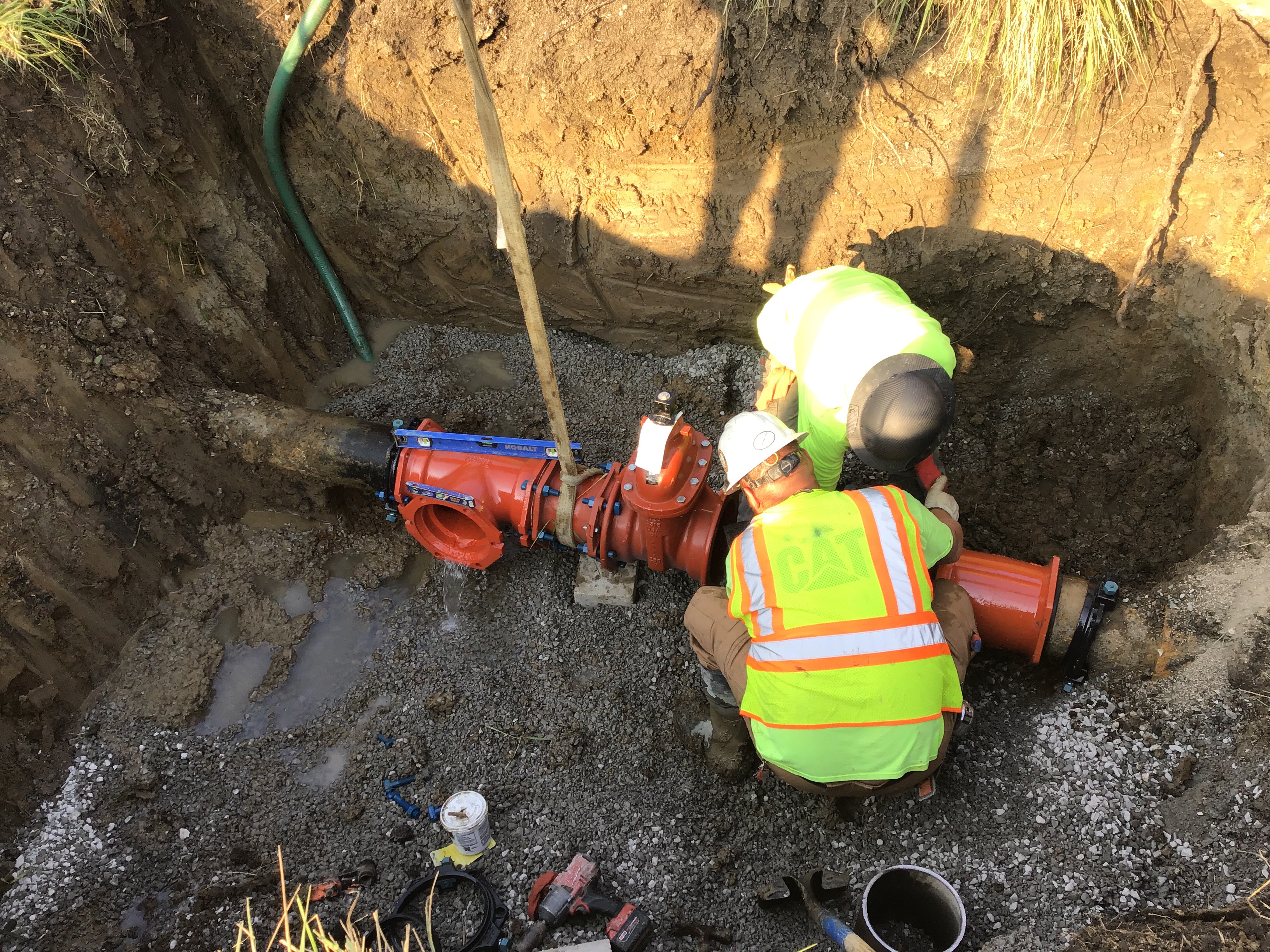

Water Line - Hydrostatic Test Passed 10/13/2020
Misc
Informational
10/13/2020
John DiMauro 10/13/2020 12:33 PM I observed the hydrostatic pressure test for the water line. The gauge was pressurized to 155 psi and it held for two hours with no drop. Test Passed.
Water Line - Construction Inspection Partial 10/16/2020
Misc
Informational
10/07/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
10/07/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
10/07/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
10/07/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
10/07/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Misc
Informational
10/07/2020
John DiMauro 10/6/2020 11:23 AM The Redford crew is working on the water main tie in alone SW Pryor RD. Ive been on site during the install to assist with shutting the water off and on all morning. The crew is currently tied into the existing main and setting pipe under the road. The water is restored at this time. Photos are uploaded.
Misc
Informational
10/07/2020
John DiMauro 10/7/2020 8:50 AM The Redford crew poured the thrust block for the tie in assembly on SW Pryor RD. The crew also poured the concrete road patch for the water line trench. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 10/16/2020 8:19 AM The Redford crew chlorinated the water lines for the project. I verified that there was at least 25 PPM of chlorine at the ends of the lines with the test strips provided.
Water Line - Coliform Test 1 Partial 10/19/2020 at 8:00 AM 10/19/2020
Misc
Informational
10/19/2020
John DiMauro 10/19/2020 12:08 PM We collected the samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 2 Partial 10/20/2020 at 8:00 AM 10/20/2020
Misc
Informational
10/20/2020
John DiMauro 10/20/2020 1:28 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 1 Failed 10/22/2020
Water Line - Coliform Test 2 Failed 10/22/2020
Misc
Informational
10/20/2020
John DiMauro 10/20/2020 1:28 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Construction Inspection Partial 10/24/2020 at 8:00 AM 10/24/2020
Misc
Informational
10/16/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
10/16/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
10/16/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Misc
Informational
10/16/2020
John DiMauro 10/6/2020 11:23 AM The Redford crew is working on the water main tie in alone SW Pryor RD. Ive been on site during the install to assist with shutting the water off and on all morning. The crew is currently tied into the existing main and setting pipe under the road. The water is restored at this time. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 10/7/2020 8:50 AM The Redford crew poured the thrust block for the tie in assembly on SW Pryor RD. The crew also poured the concrete road patch for the water line trench. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 10/16/2020 8:19 AM The Redford crew chlorinated the water lines for the project. I verified that there was at least 25 PPM of chlorine at the ends of the lines with the test strips provided.
Misc
Informational
10/24/2020
John DiMauro 10/24/2020 9:34 AM - After Hours Inspection. I observed the flushing of the water mains to prepare for the second set of bacteria samples coming up on Monday 10/26/2020.
Water Line - Coliform Test 1 Partial 10/26/2020
Misc
Informational
10/26/2020
John DiMauro 10/26/2020 11:32 AM I collected this round of day 1 samples and delivered them to Keystone Lab. We will know the results in 24 Hours.
Water Line - Coliform Test 2 Partial 10/27/2020
Misc
Informational
10/22/2020
John DiMauro 10/20/2020 1:28 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Misc
Informational
10/27/2020
John DiMauro 10/70/2020 1:30 PM We collected the Second round of day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Construction Inspection Partial 10/28/2020
Misc
Informational
10/24/2020
The Redford crew started installing the crossings for water line 2. Photos of the work are uploaded.
Misc
Informational
10/24/2020
The crew continued the install of water line 2. The crew set the hydrant at station 4+48.69 and the valve cluster at station 5+25.05 They stopped at station 5+25.05 and are in the process of pouring the thrust blocks for the line. Photos of the work and concrete ticket have been uploaded.
Misc
Informational
10/24/2020
John DiMauro 9/24/2020 10:22 AM The Redford Construction crew is starting the Water Line 1 install today. The crew removed the temporary hydrant assembly and tied on to the existing line. The crew set approx 60’ ft of the 8” in C900 water line. The tee for the permanent hydrant at station 0+00 has been installed. Photos are uploaded.
Misc
Informational
10/24/2020
John DiMauro 9/25/2020 7:58 AM The Redford crew installed approx 600’ ft of the 8” main line 1. Photos are uploaded.
Misc
Informational
10/24/2020
John DiMauro 9/29/2020 The Redford crew installed the thrust blocks for the bends around the curl-de-sac. Water line 1 is now installed. The crew plans to backfill today.
Misc
Informational
10/24/2020
John DiMauro 10/6/2020 11:23 AM The Redford crew is working on the water main tie in alone SW Pryor RD. Ive been on site during the install to assist with shutting the water off and on all morning. The crew is currently tied into the existing main and setting pipe under the road. The water is restored at this time. Photos are uploaded.
Misc
Informational
10/24/2020
John DiMauro 10/7/2020 8:50 AM The Redford crew poured the thrust block for the tie in assembly on SW Pryor RD. The crew also poured the concrete road patch for the water line trench. Photos are uploaded.
Misc
Informational
10/24/2020
John DiMauro 10/16/2020 8:19 AM The Redford crew chlorinated the water lines for the project. I verified that there was at least 25 PPM of chlorine at the ends of the lines with the test strips provided.
Misc
Informational
10/24/2020
John DiMauro 10/24/2020 9:34 AM - After Hours Inspection. I observed the flushing of the water mains to prepare for the second set of bacteria samples coming up on Monday 10/26/2020.
Misc
Informational
10/28/2020
John DiMauro 10/28/2020 Redford Crew installed additional construction taps for the water sample locations and then flushed the line to prepare for another round of water samples.
Water Line - Coliform Test 1 Passed 11/02/2020
Misc
Resolved
11/02/2020
John DiMauro 10/26/2020 11:32 AM I collected this round of day 1 samples and delivered them to Keystone Lab. We will know the results in 24 Hours.
Misc
Informational
11/02/2020
John DiMauro 11/02/2020 Reports are uploaded.
Water Line - Coliform Test 2 Passed 11/02/2020
Misc
Resolved
11/02/2020
John DiMauro 10/20/2020 1:28 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Misc
Resolved
11/02/2020
John DiMauro 10/70/2020 1:30 PM We collected the Second round of day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Misc
Informational
11/02/2020
John DiMauro 11/02/2020 Reports are uploaded.
Record Drawing Review Passed 6/3/2021 07/01/2021
Documents & Images
Date Uploaded File Type Document Name
07/15/2019 Receipt Receipt for transaction: 2019-004786
07/15/2019 Receipt Receipt for transaction: 2019-004787
10/03/2019 Receipt Receipt for transaction: 2019-006606
10/14/2019 Letter DE-Permit
10/15/2019 Reserve @ Stoney Creek 4th Plat Signed Permit

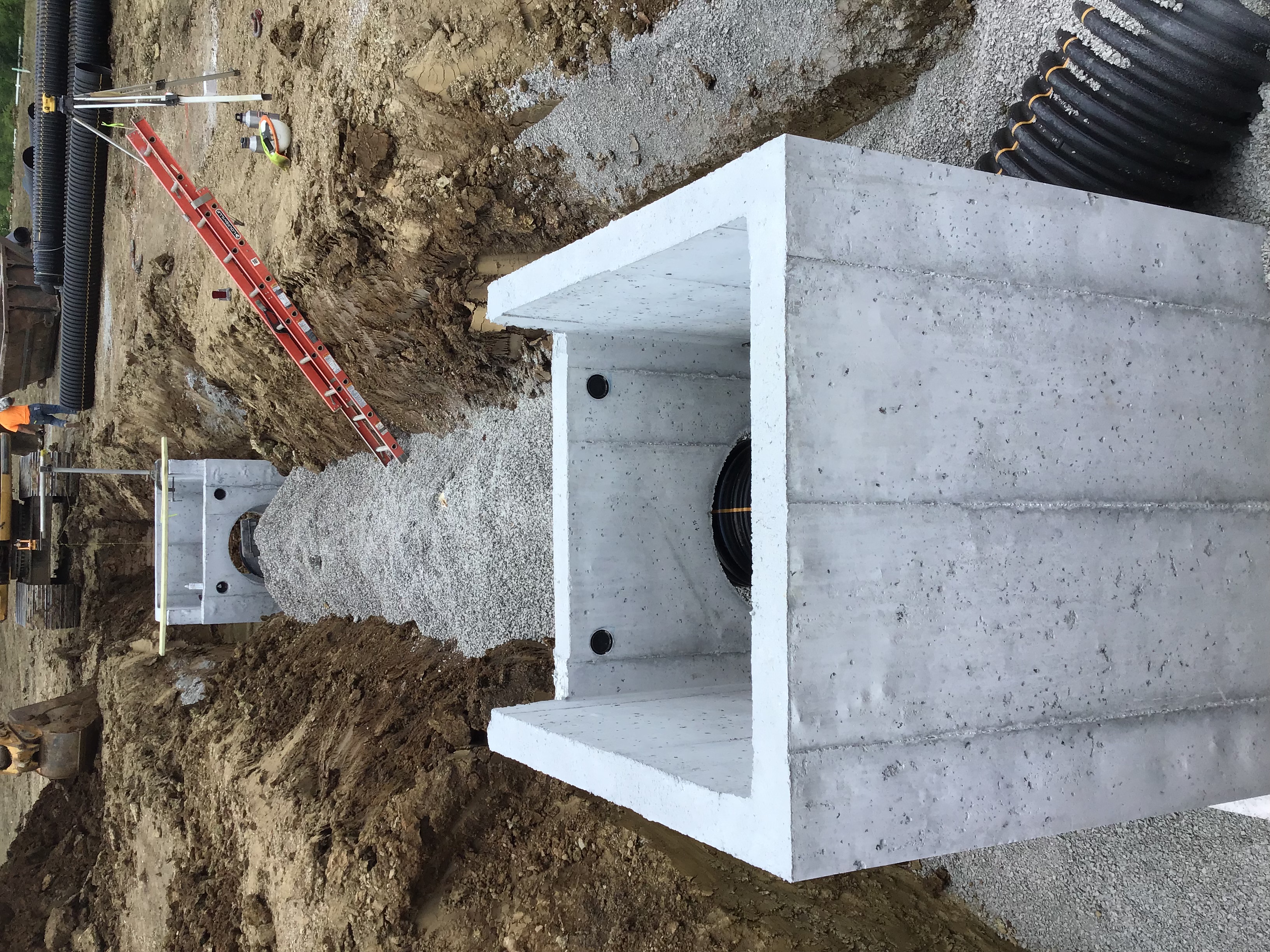

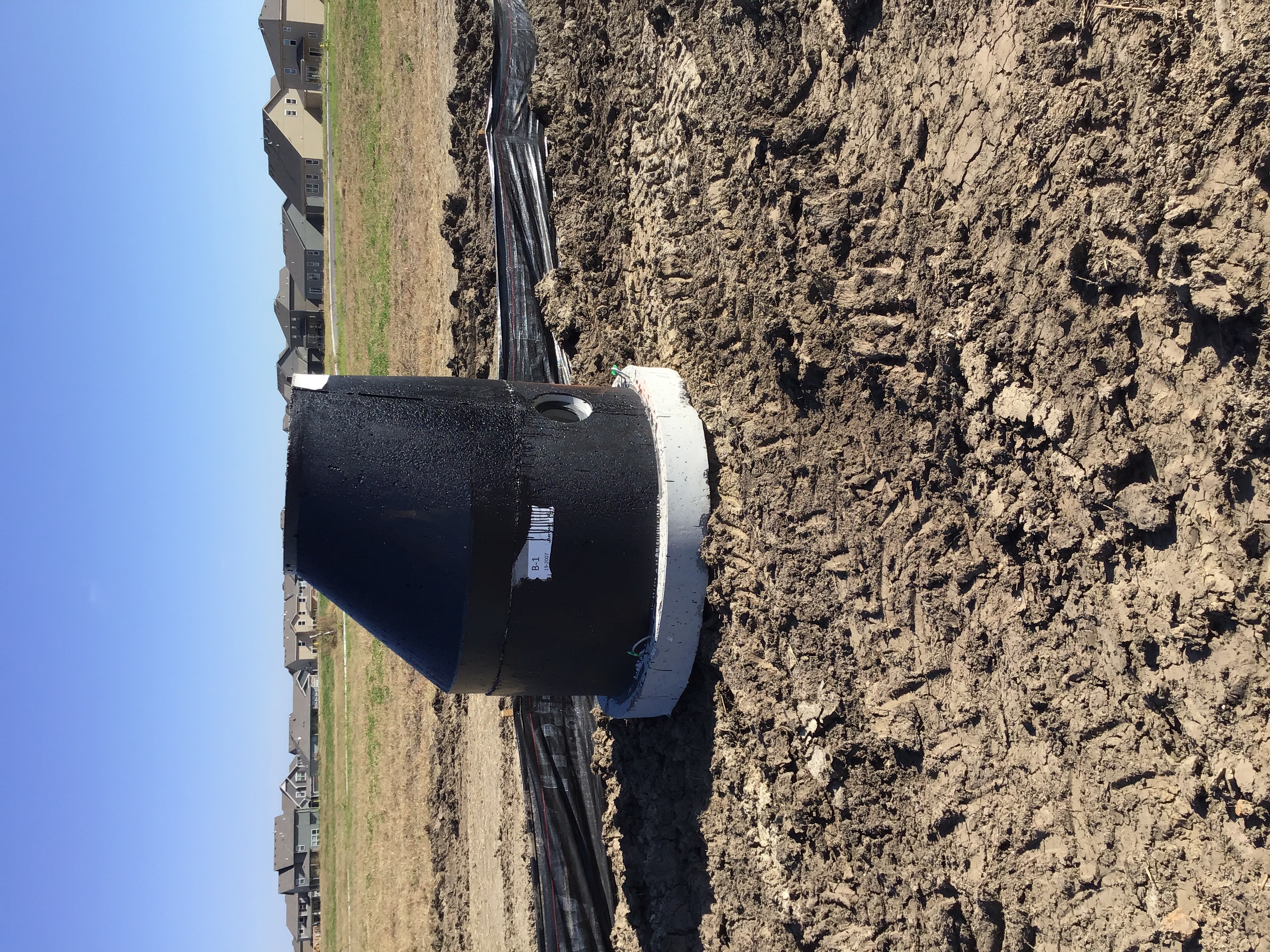

10/18/2019 MH core
10/18/2019 MH collar extensions
10/18/2019 New MH
10/18/2019 MH B1
10/18/2019 MH B2
10/18/2019 Tracer boxes

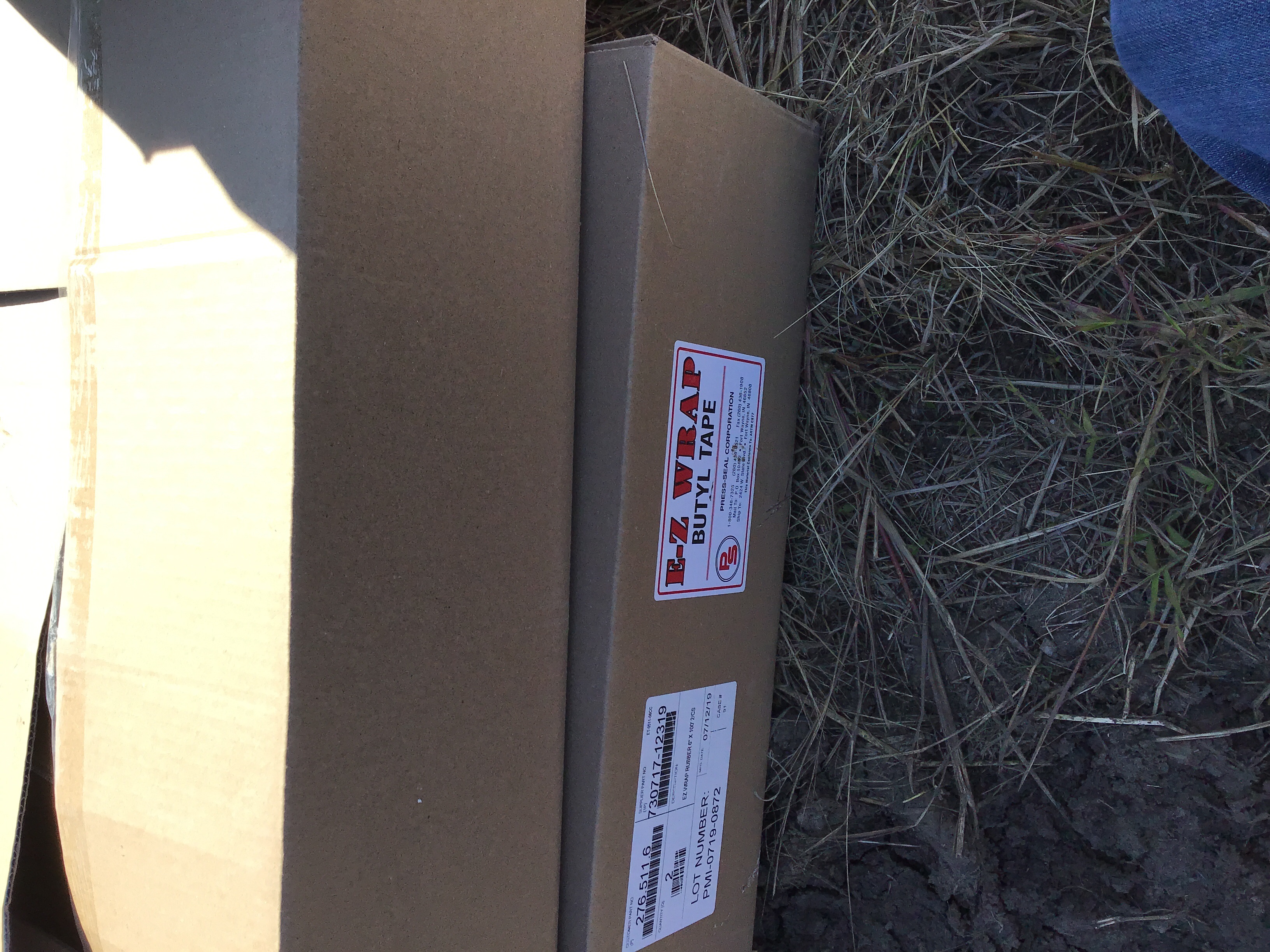

10/18/2019 Material verified fittings
10/18/2019 Materials verified fittings
10/18/2019 Materials verified Wye
10/18/2019 Materials verified anode
10/18/2019 Materials verified butyl tape
10/18/2019 Materials verified 4” pipe
10/18/2019 Materials verified 4” pipe
10/18/2019 Materials verified 8” pipe
10/18/2019 Materials verified 8” pipe
10/18/2019 MH B1 cone
10/18/2019 Letter INSPECTION SUMMARY
10/18/2019 Letter INSPECTION SUMMARY
10/18/2019 Letter INSPECTION SUMMARY
10/22/2019 Letter INSPECTION SUMMARY
10/23/2019 Lateral trench checks
10/23/2019 Lateral trench checks 0
10/23/2019 Lateral trench check
10/23/2019 Lateral trench check0
10/23/2019 Lateral trench check
10/23/2019 Lateral trench check 0
10/23/2019 Letter INSPECTION SUMMARY
03/19/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
06/03/2020 Letter INSPECTION SUMMARY
06/03/2020 Storm line 1.jpeg
06/03/2020 Storm line 1.jpeg0
06/03/2020 Storm line 1.jpeg1
06/09/2020 Letter INSPECTION SUMMARY
06/09/2020 CI 1-3.jpg
06/09/2020 Invert CI 1-3.jpg
06/09/2020 CI 1-4.jpg
06/09/2020 Invert CI 1-4.jpg
06/09/2020 Storm Line 2.jpg
06/09/2020 FI 2-1.jpg
06/09/2020 FI 2-1 & Collar.jpg
06/09/2020 Existing FI 7-1 tie in.jpg
06/09/2020 7-1 tie in invert.jpg
06/10/2020 FI 2-2 collar.jpg
06/10/2020 Invert FI 2-2.jpg
06/10/2020 FI 2-1 collar.jpg
06/10/2020 FI 2-1 invert.jpg
06/10/2020 Letter INSPECTION SUMMARY
06/10/2020 Basin outlet and Rip Rap.jpg
06/10/2020 Letter INSPECTION SUMMARY

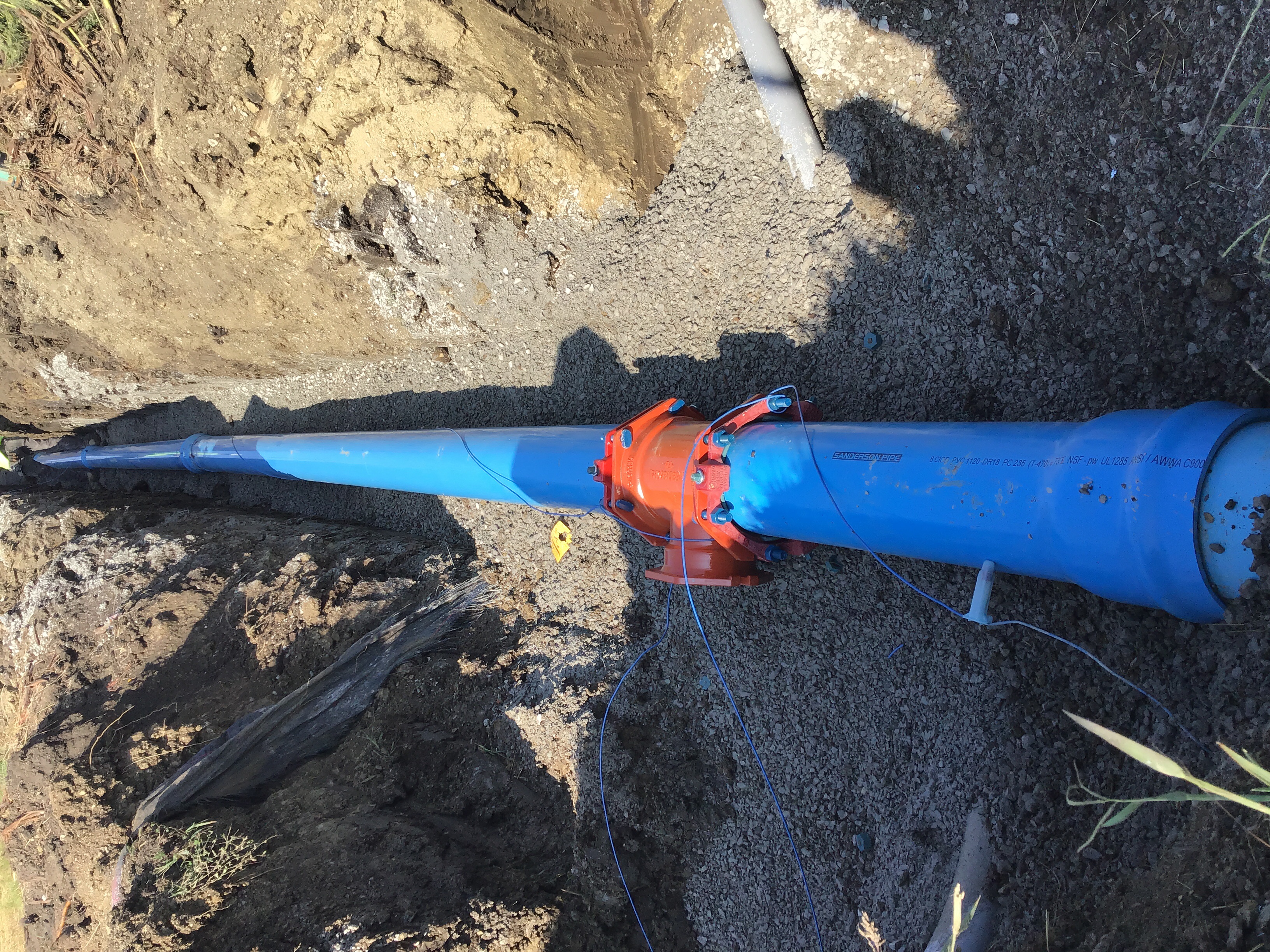

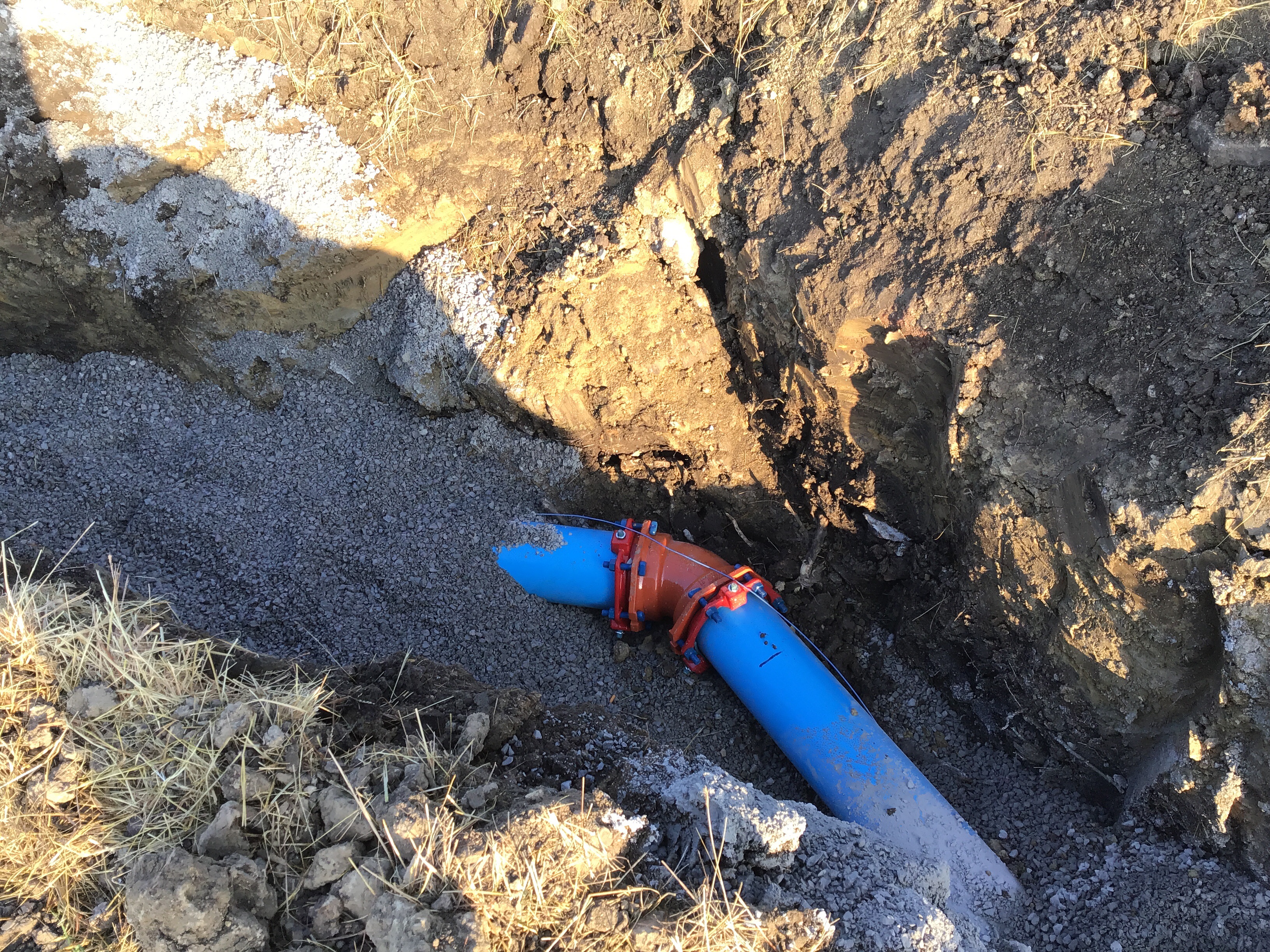

06/10/2020 Water line 2.jpg
06/11/2020 Letter INSPECTION SUMMARY
06/11/2020 Water line two 12” butterfly valve. .jpeg
06/11/2020 Water line two 11.25 bend.jpeg
06/11/2020 Water line 2 hydrant.jpg
06/11/2020 Water line 2.jpg0
06/11/2020 Valves at station 5+25.05.jpg

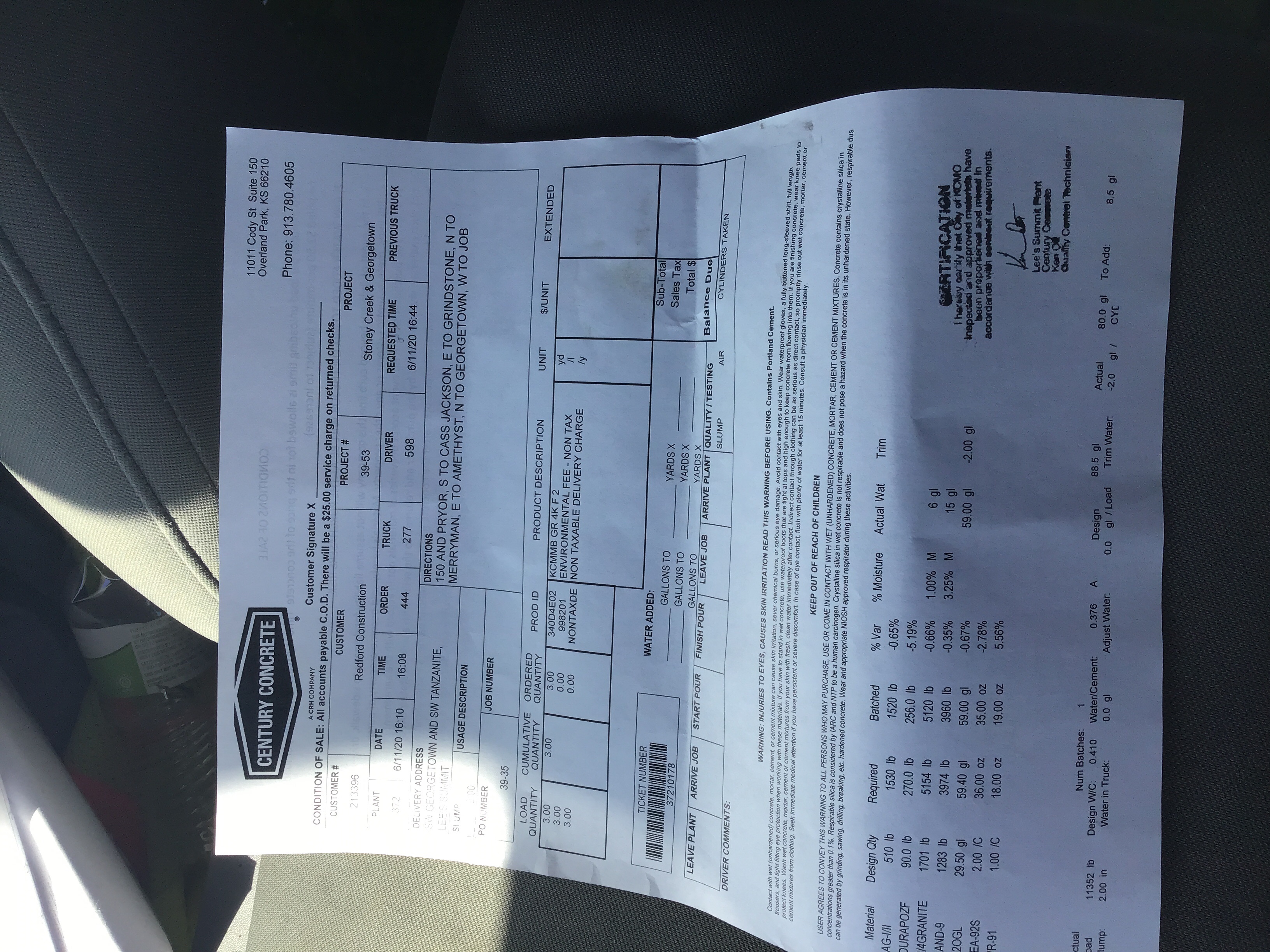

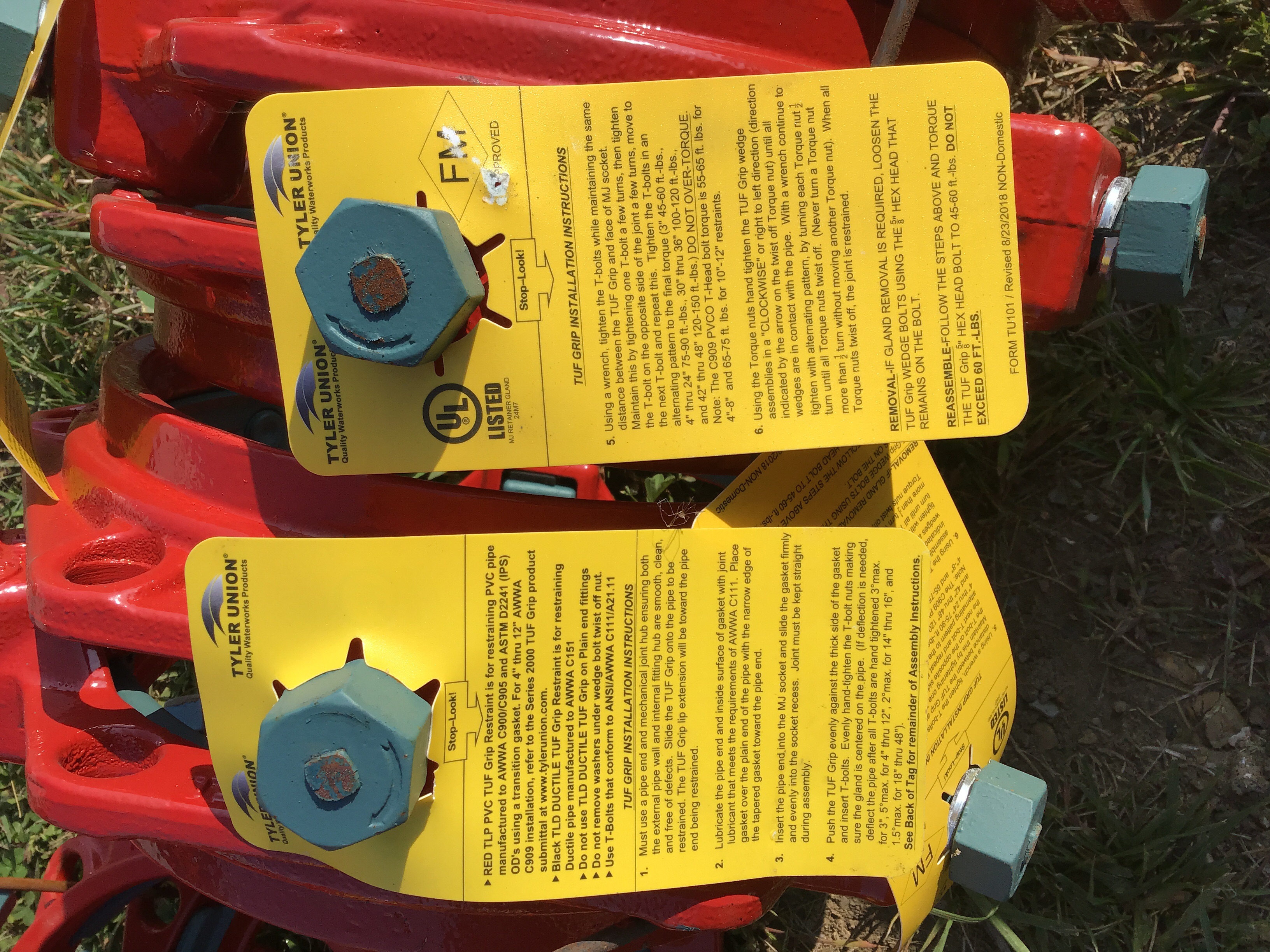

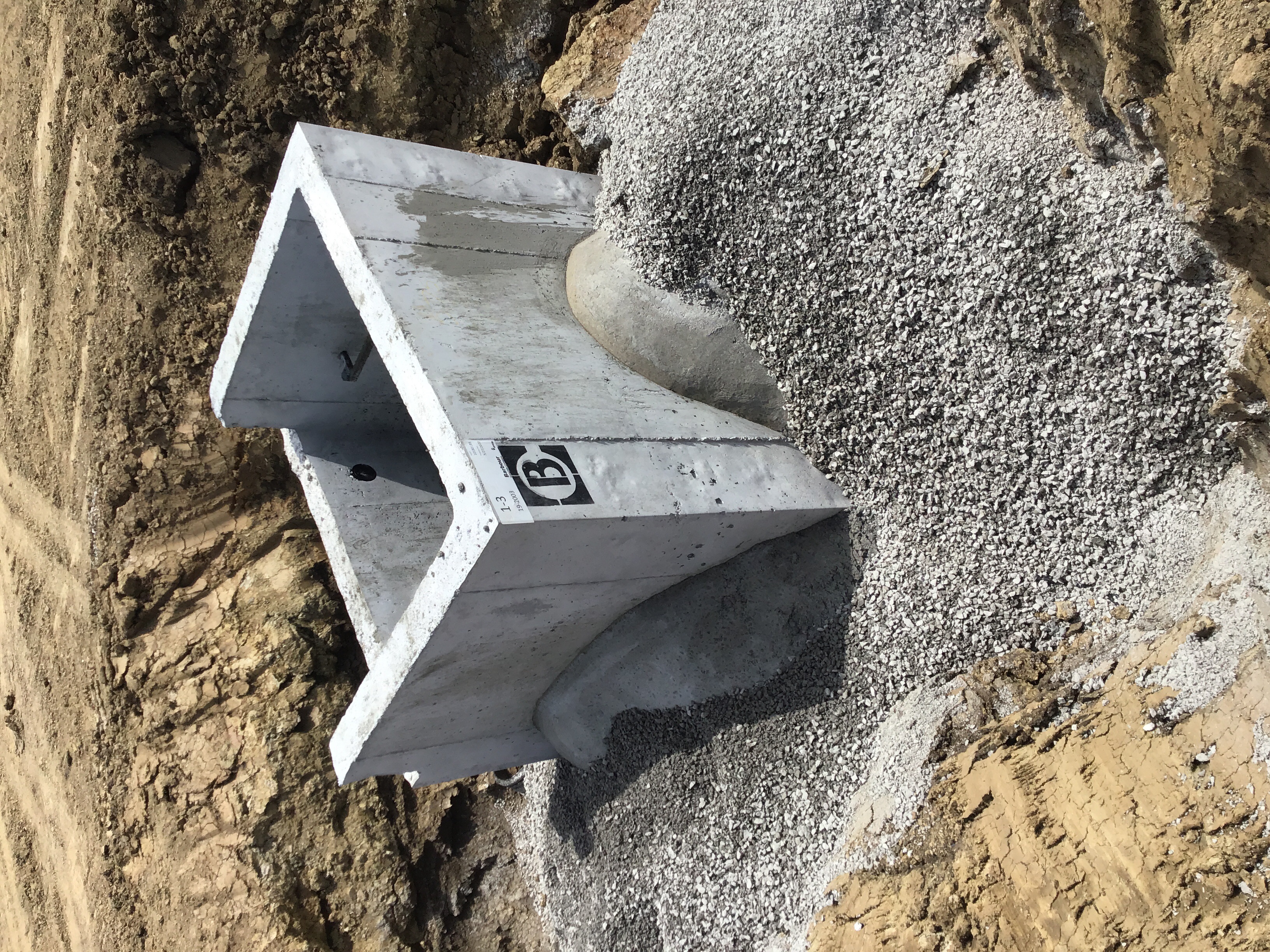

06/11/2020 Ticket for thrust blocks on water line 2.jpg
06/11/2020 Letter INSPECTION SUMMARY

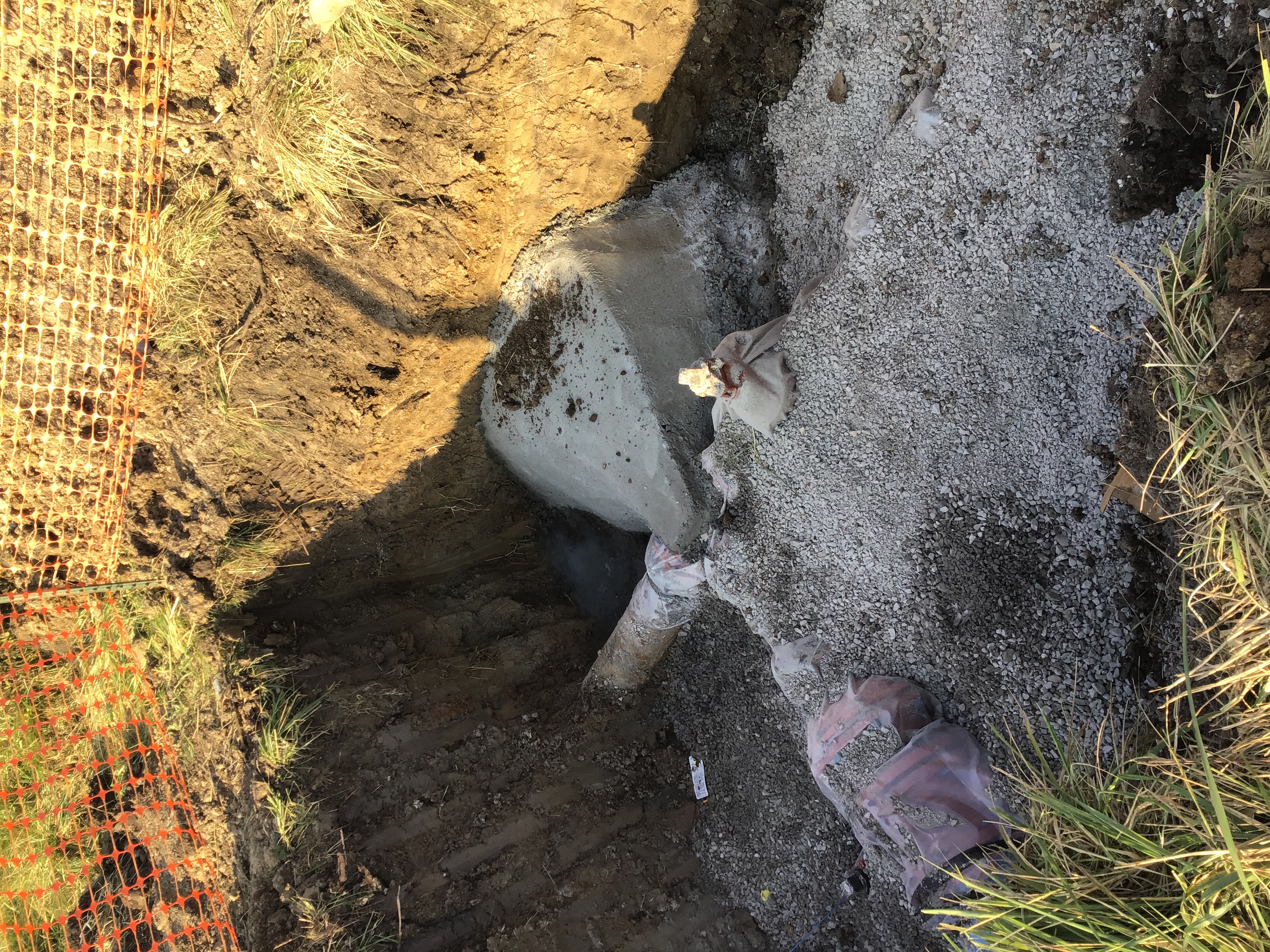

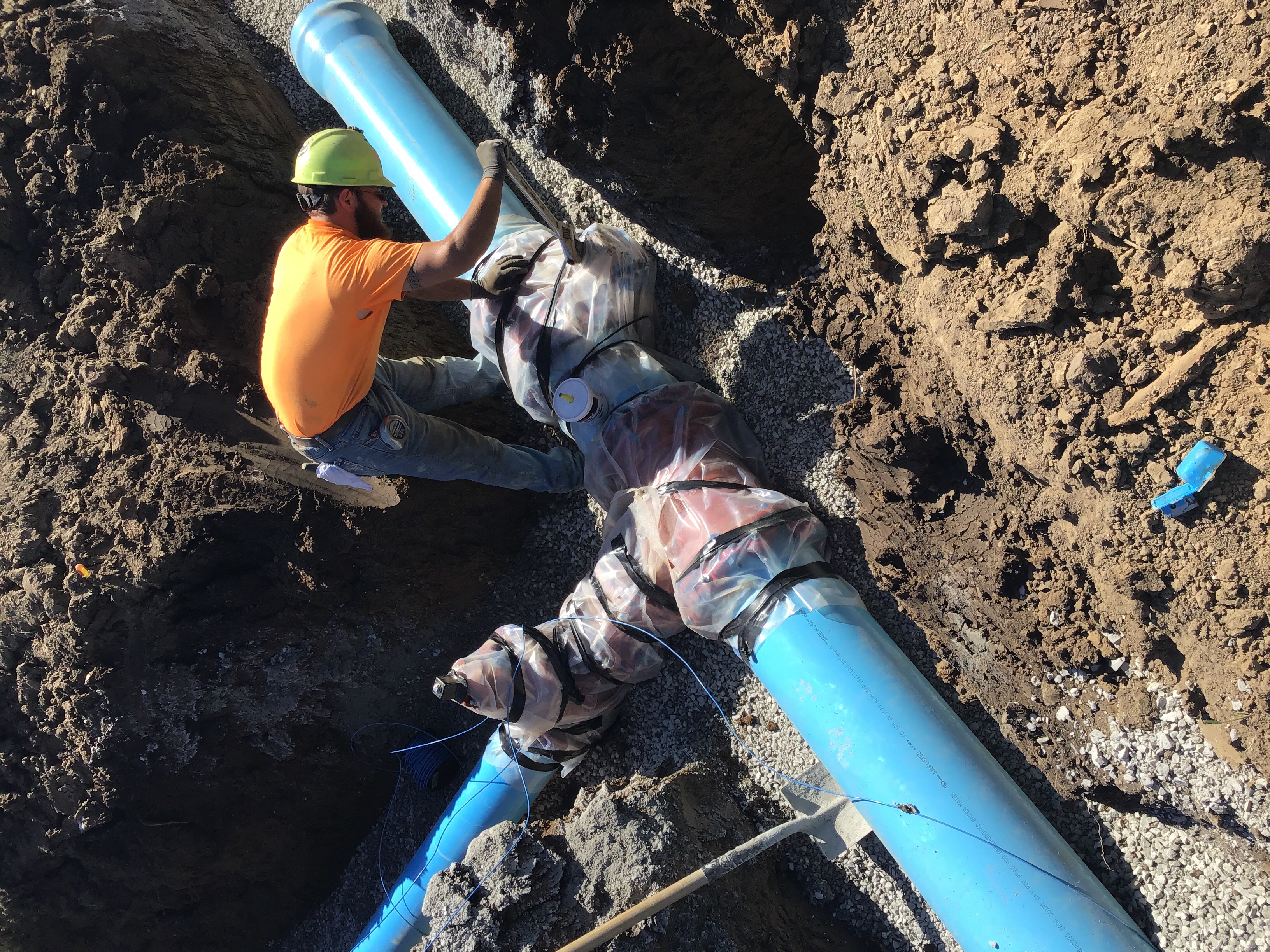

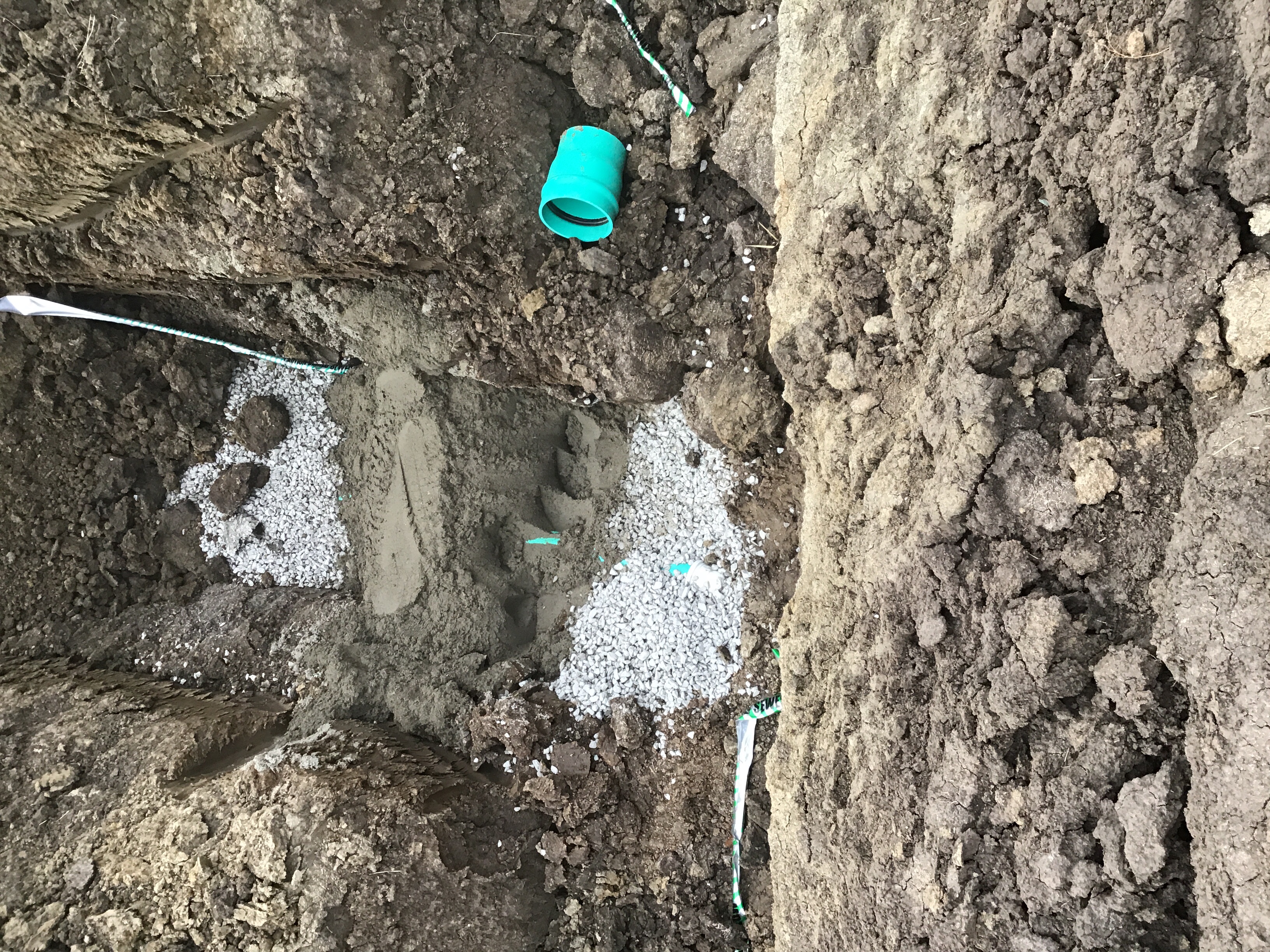

06/11/2020 Thrust block on valve at station 5+25.jpg
06/11/2020 WL 2 block at hydrant assembly.jpg
06/11/2020 WL2 block at tee for hydrant.jpg

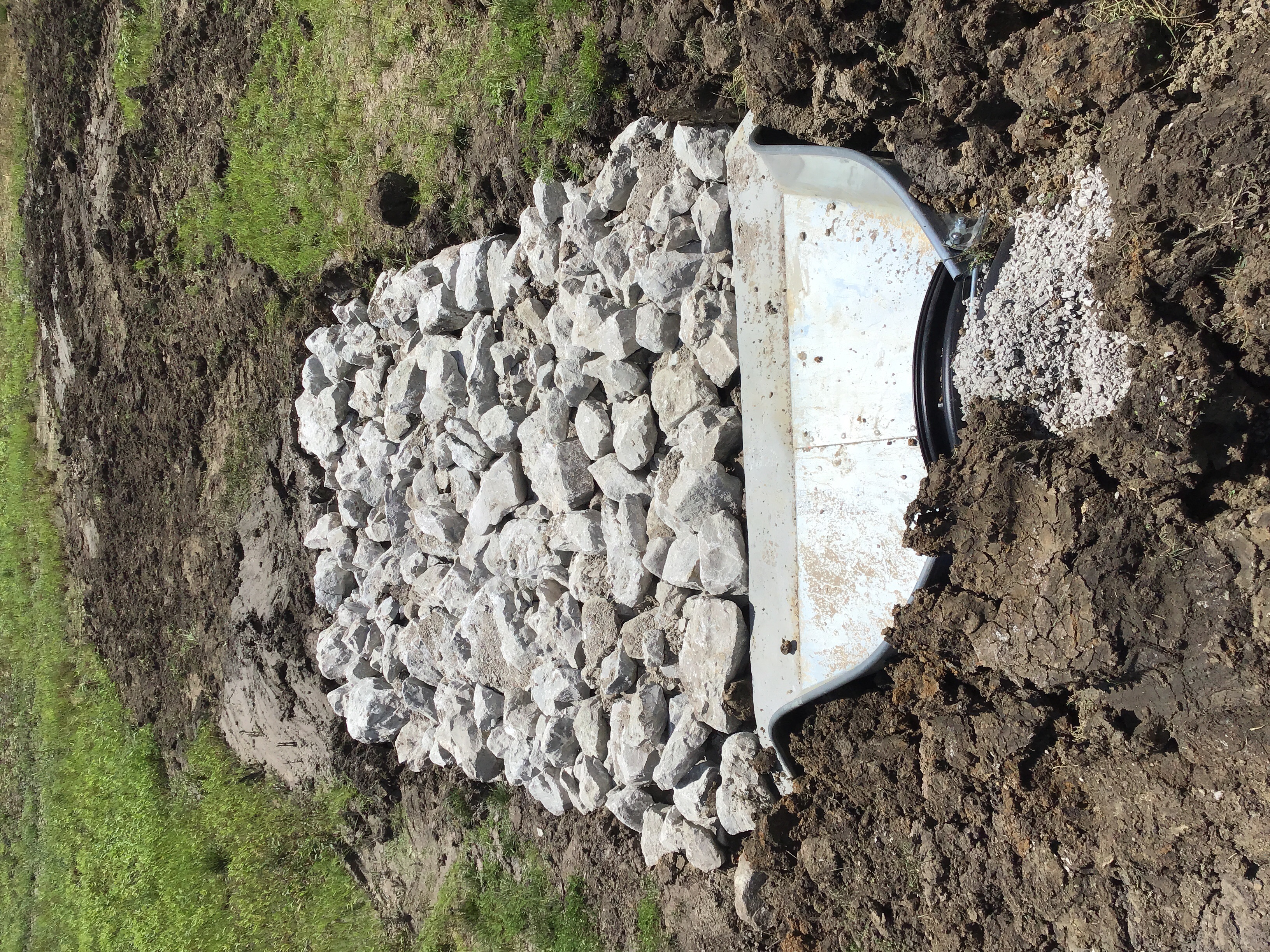

06/11/2020 WL2 locate tape.jpg
06/11/2020 WL2 thrust block at 11.25 bend.jpg
06/11/2020 WL2 thrust block for valve at 2+00.jpg
06/18/2020 Letter DE-Daily Inspection Summary
07/22/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter INSPECTION SUMMARY
07/24/2020 Letter INSPECTION SUMMARY
07/29/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/13/2020 Letter INSPECTION SUMMARY
08/20/2020 Letter INSPECTION SUMMARY
08/20/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
08/31/2020 Letter INSPECTION SUMMARY

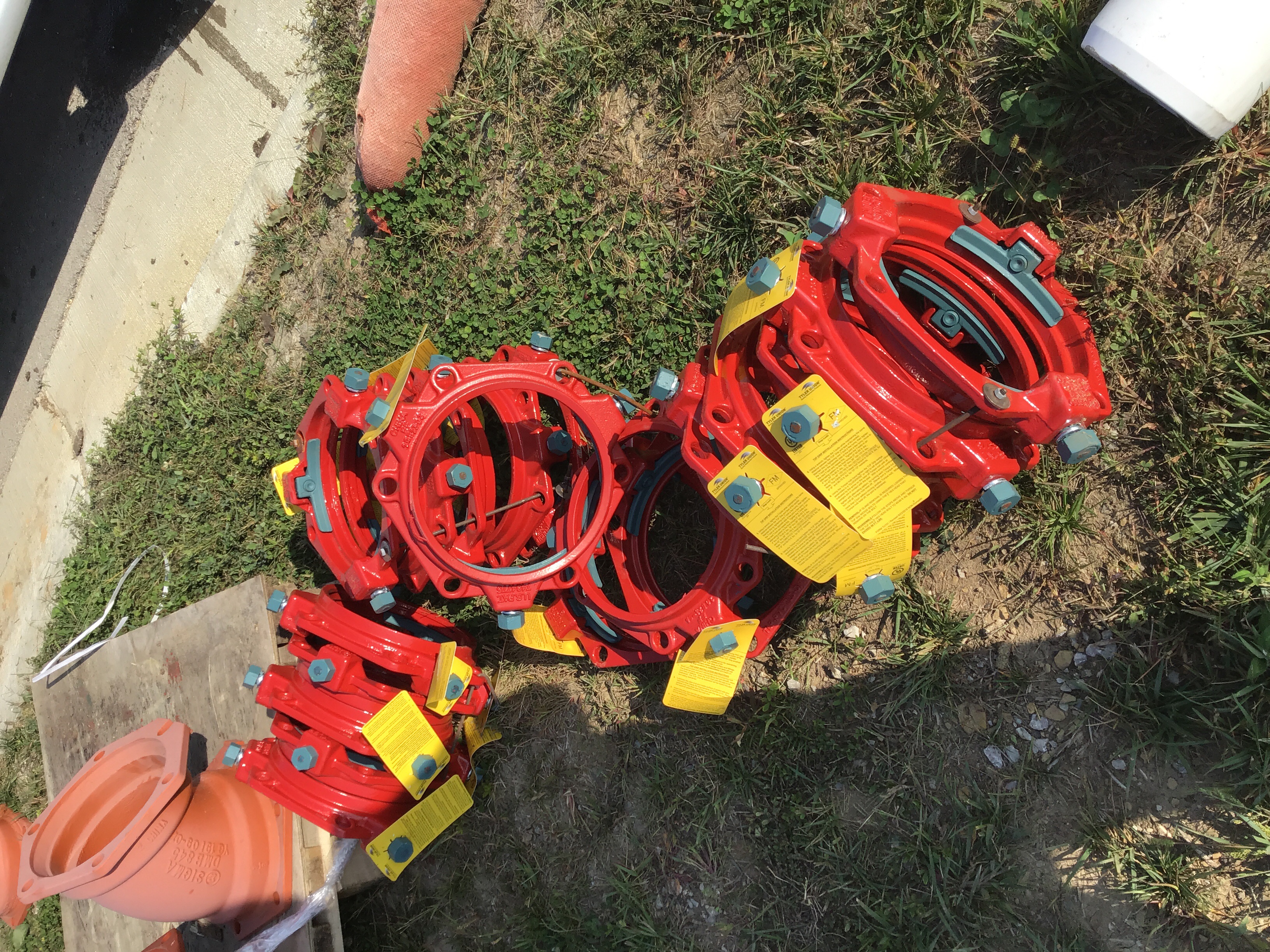

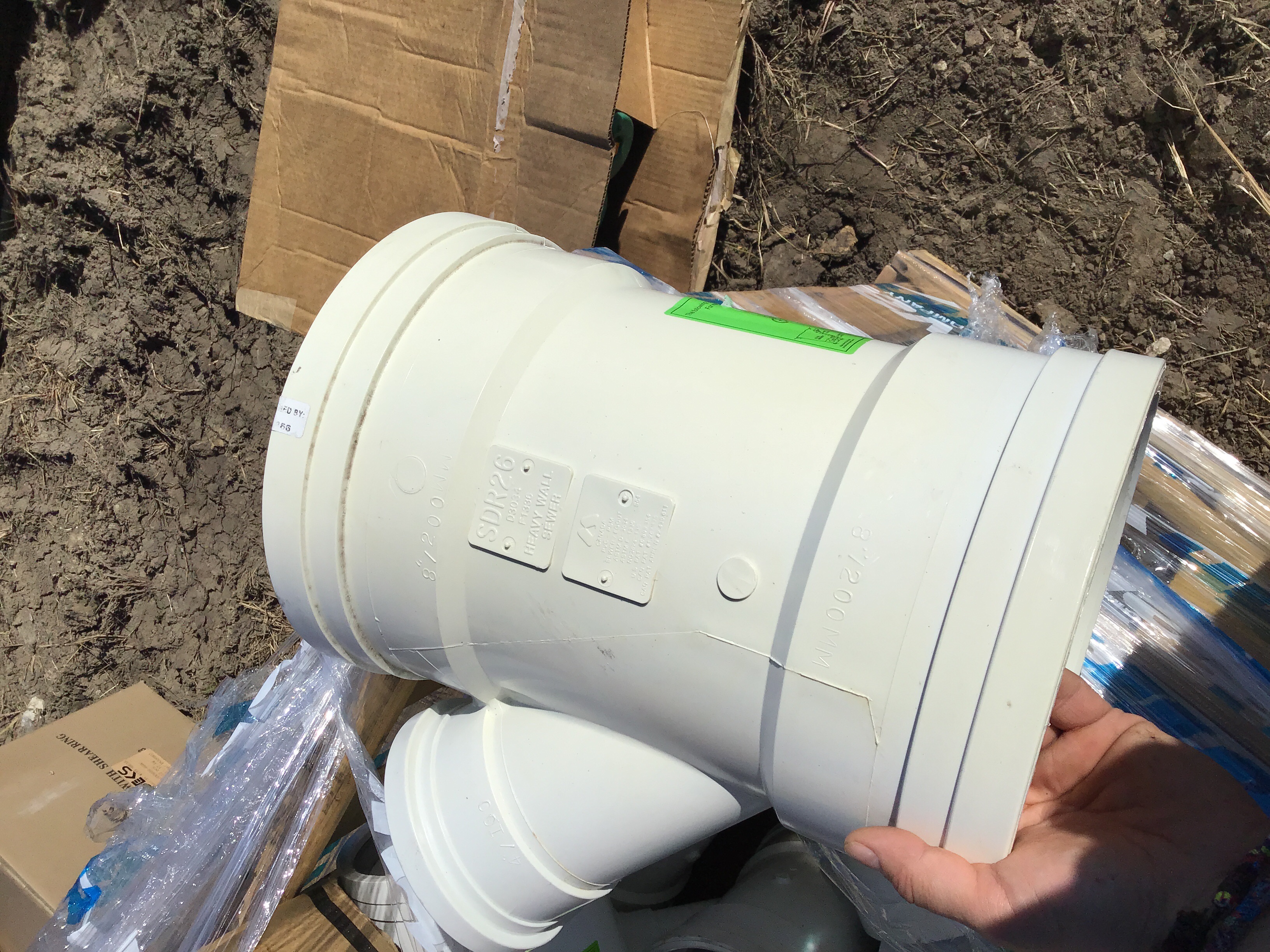

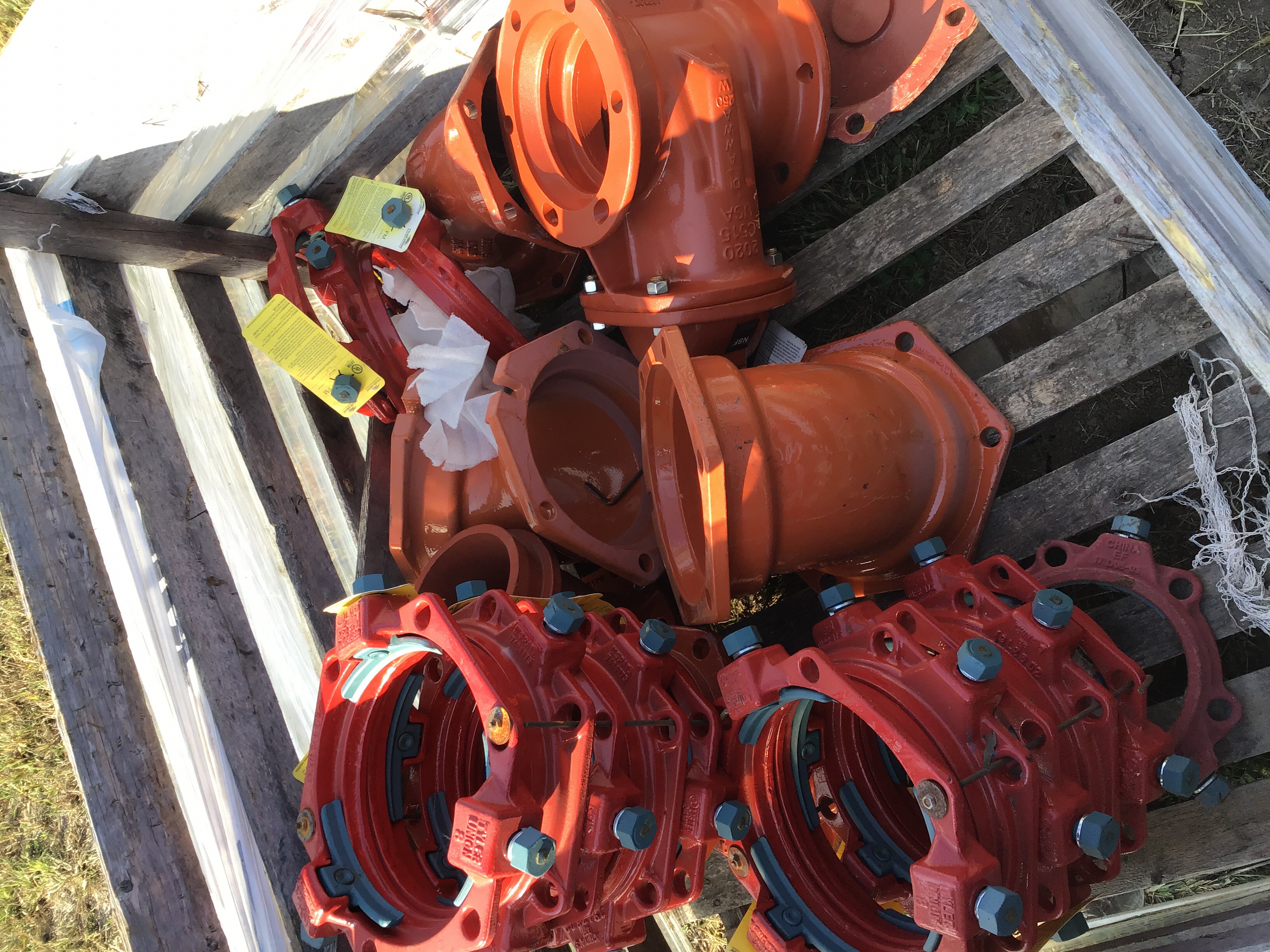

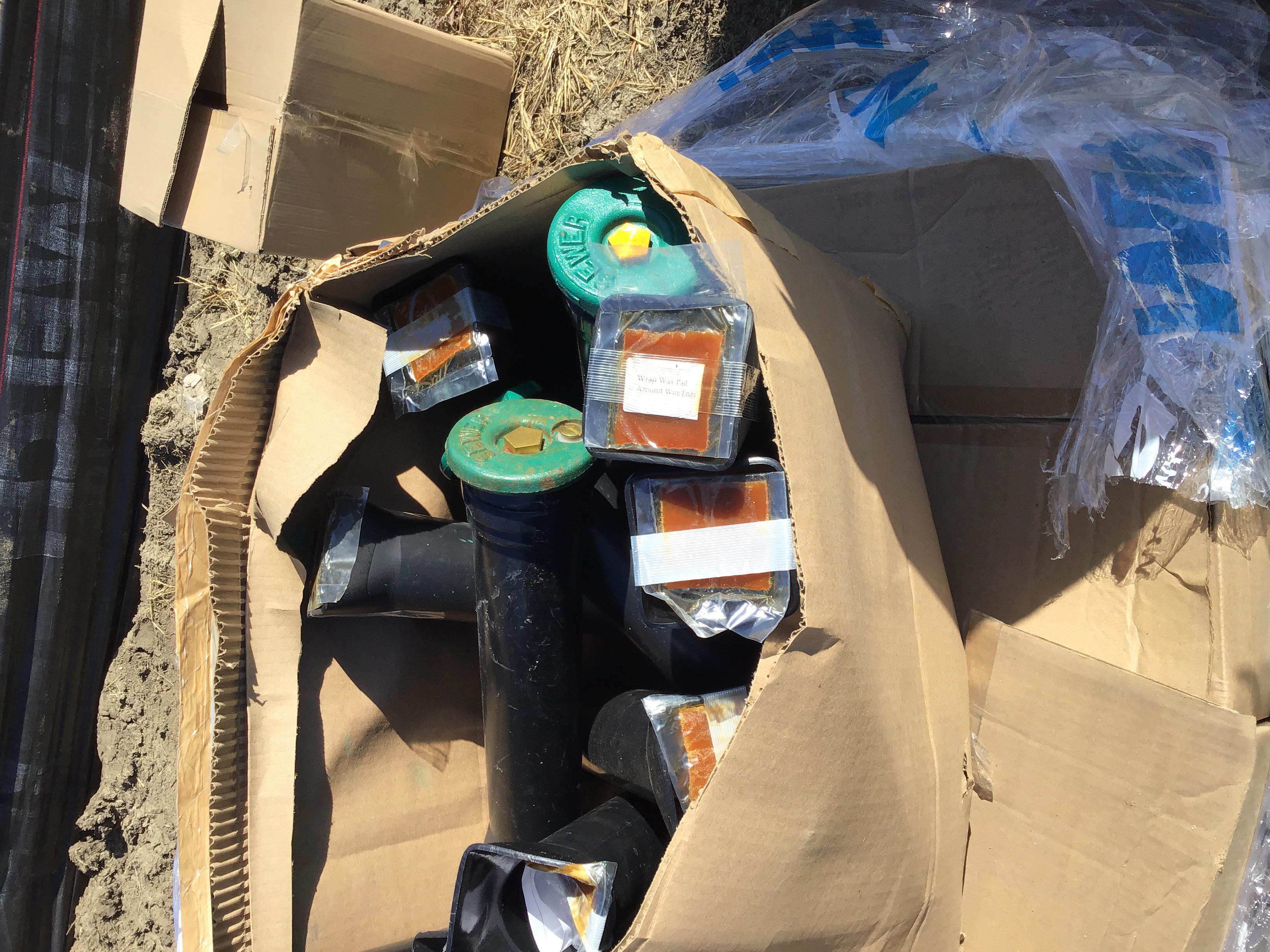

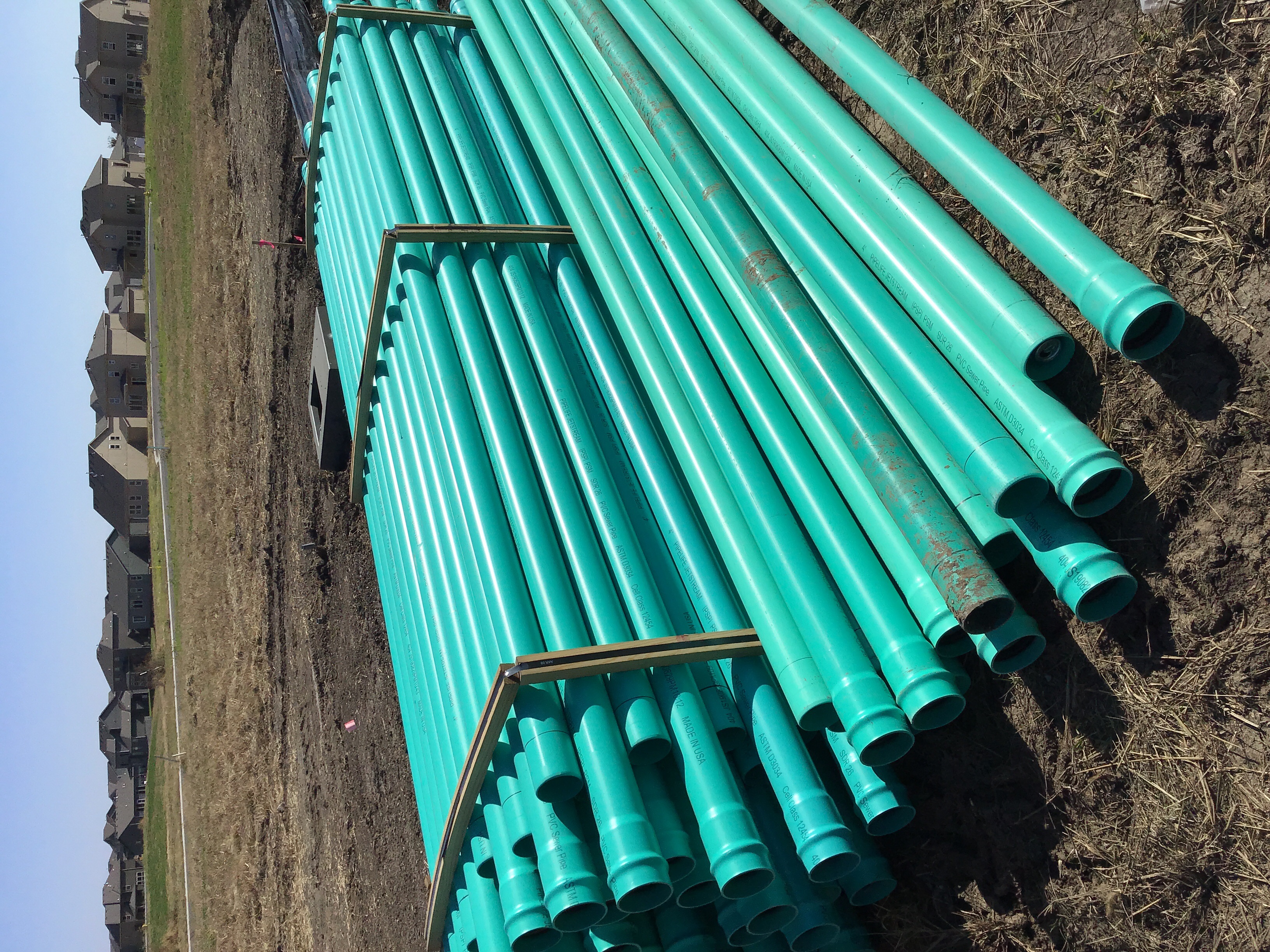

09/24/2020 Water line Materials .jpg
09/24/2020 Water Line Materials .jpg0
09/24/2020 Water Line Materials .jpg1
09/24/2020 Water Line Materials .jpg2
09/24/2020 Water Line Materials .jpg3
09/24/2020 Water line Materials .jpg4
09/24/2020 Water Line Materials .jpg5
09/24/2020 Water Line Materials .jpg6
09/24/2020 Water Line Materials .jpg7

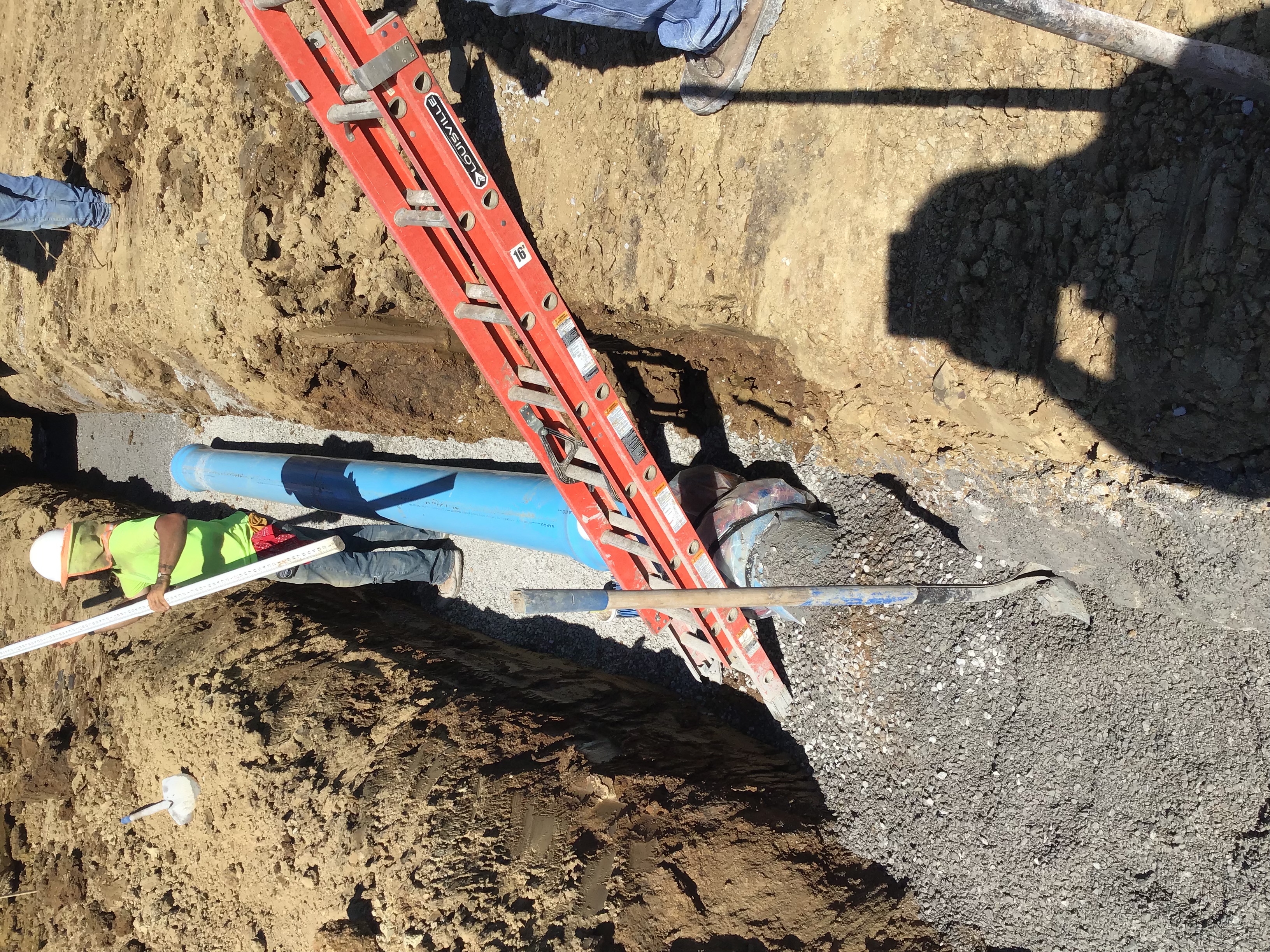

09/24/2020 Water line 1 Install.jpg
09/24/2020 Letter INSPECTION SUMMARY
09/24/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter INSPECTION SUMMARY
09/25/2020 WATER LINE 1.jpg
09/25/2020 WATER LINE 1.jpg0
09/25/2020 Water line 1.jpg1
09/25/2020 Water line 1.jpg2

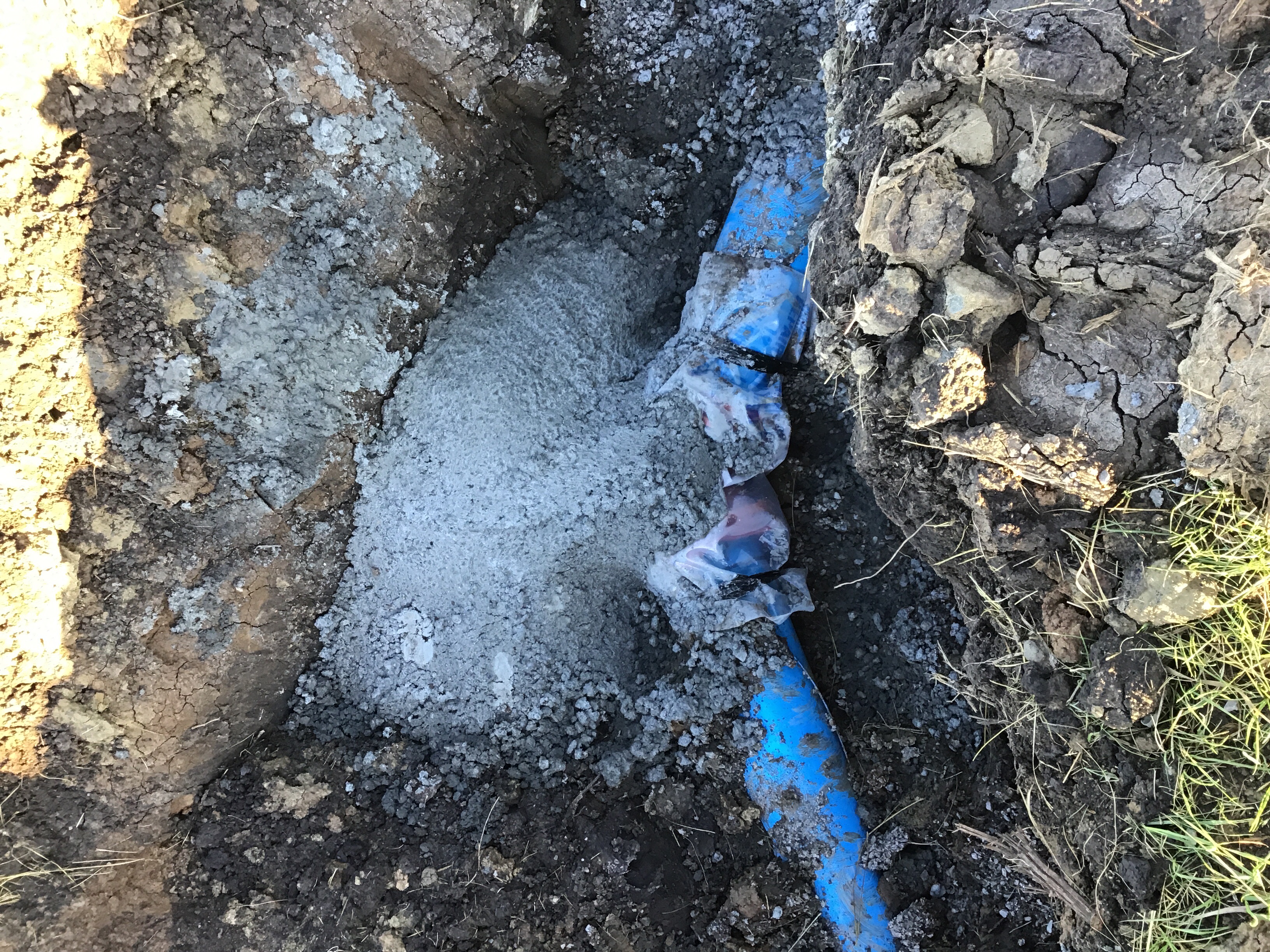

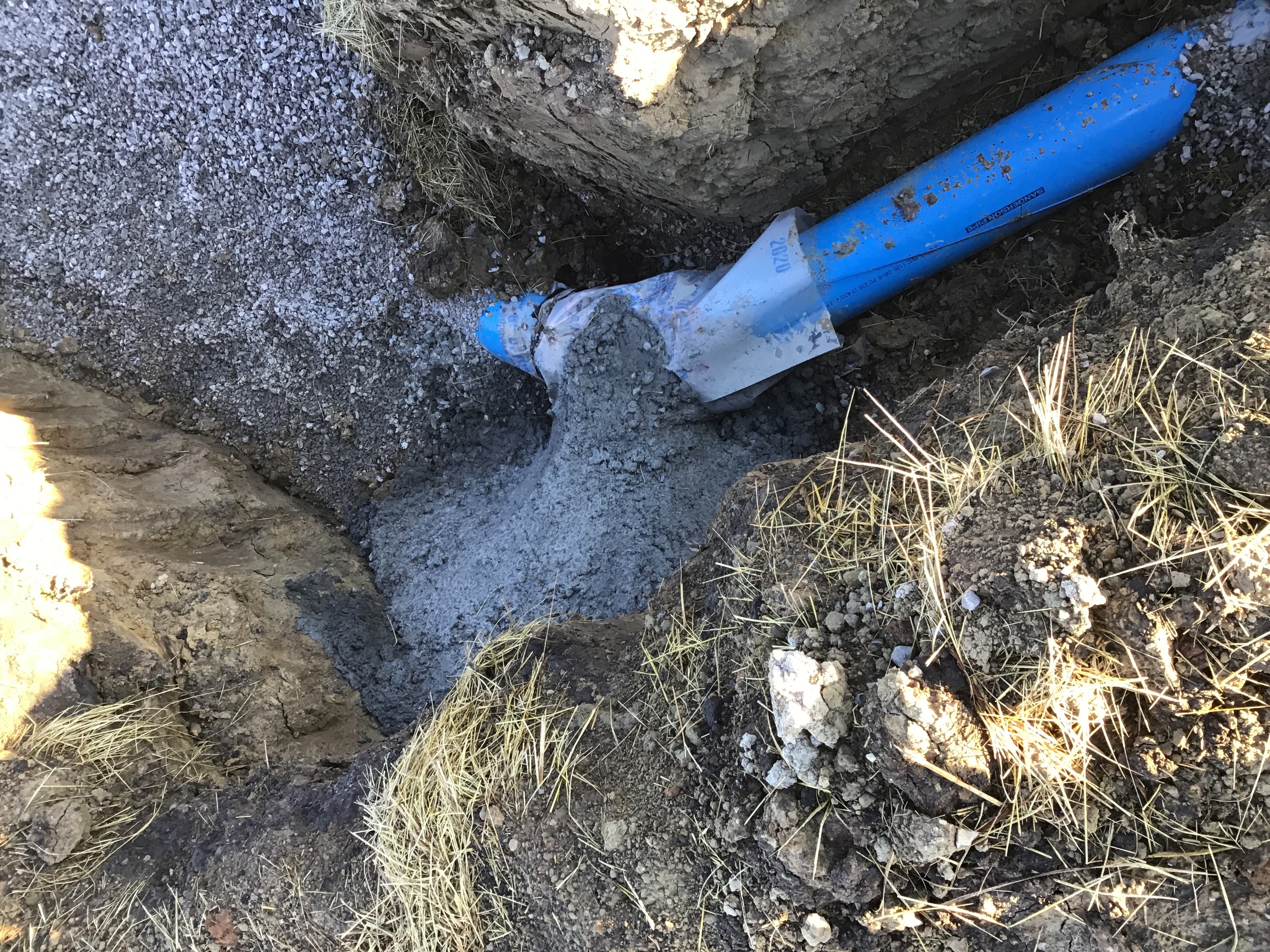

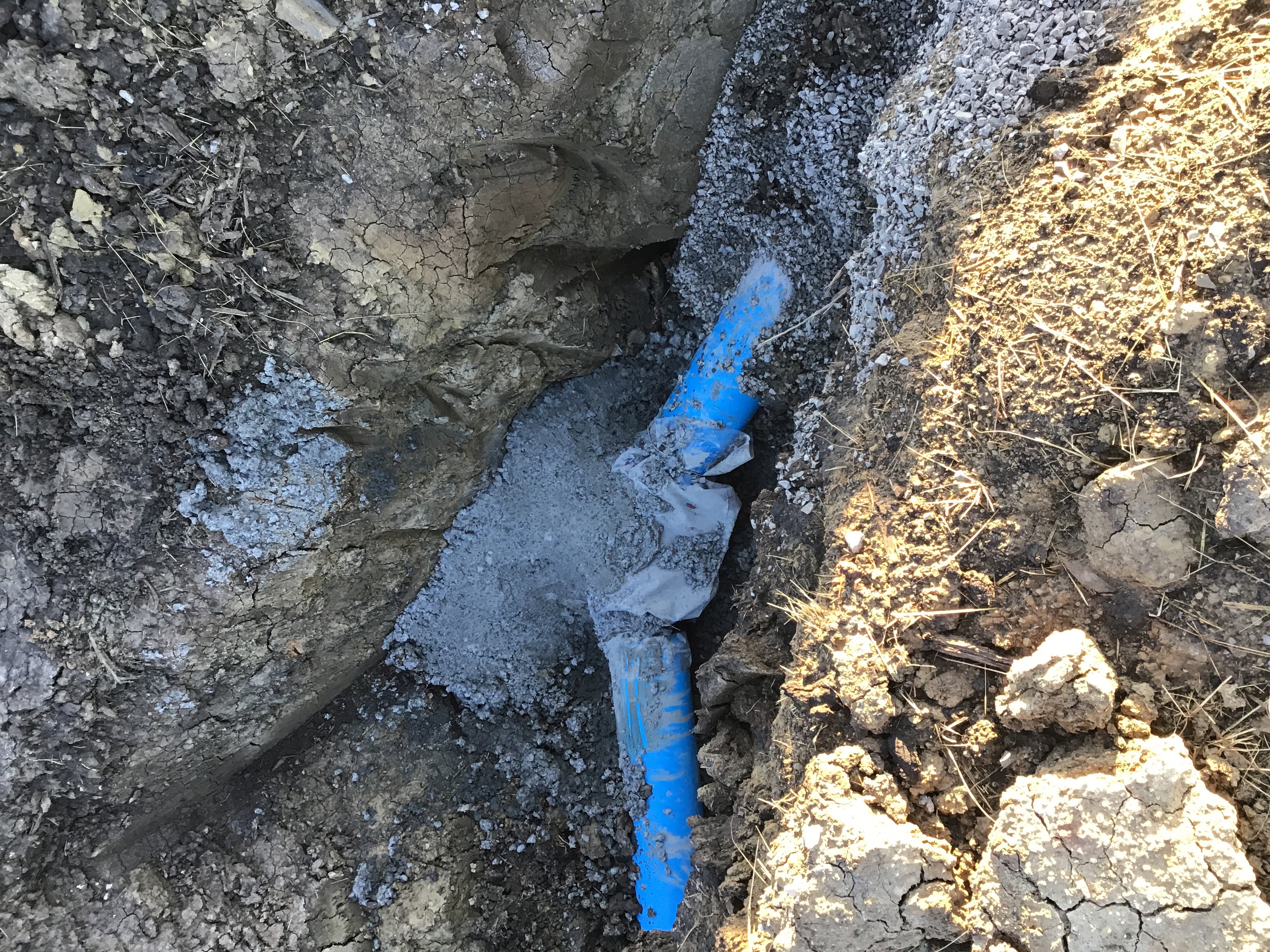

09/29/2020 Thrust block.jpg
09/29/2020 T block.jpg
09/29/2020 T block.jpg0
09/29/2020 T block.jpg1

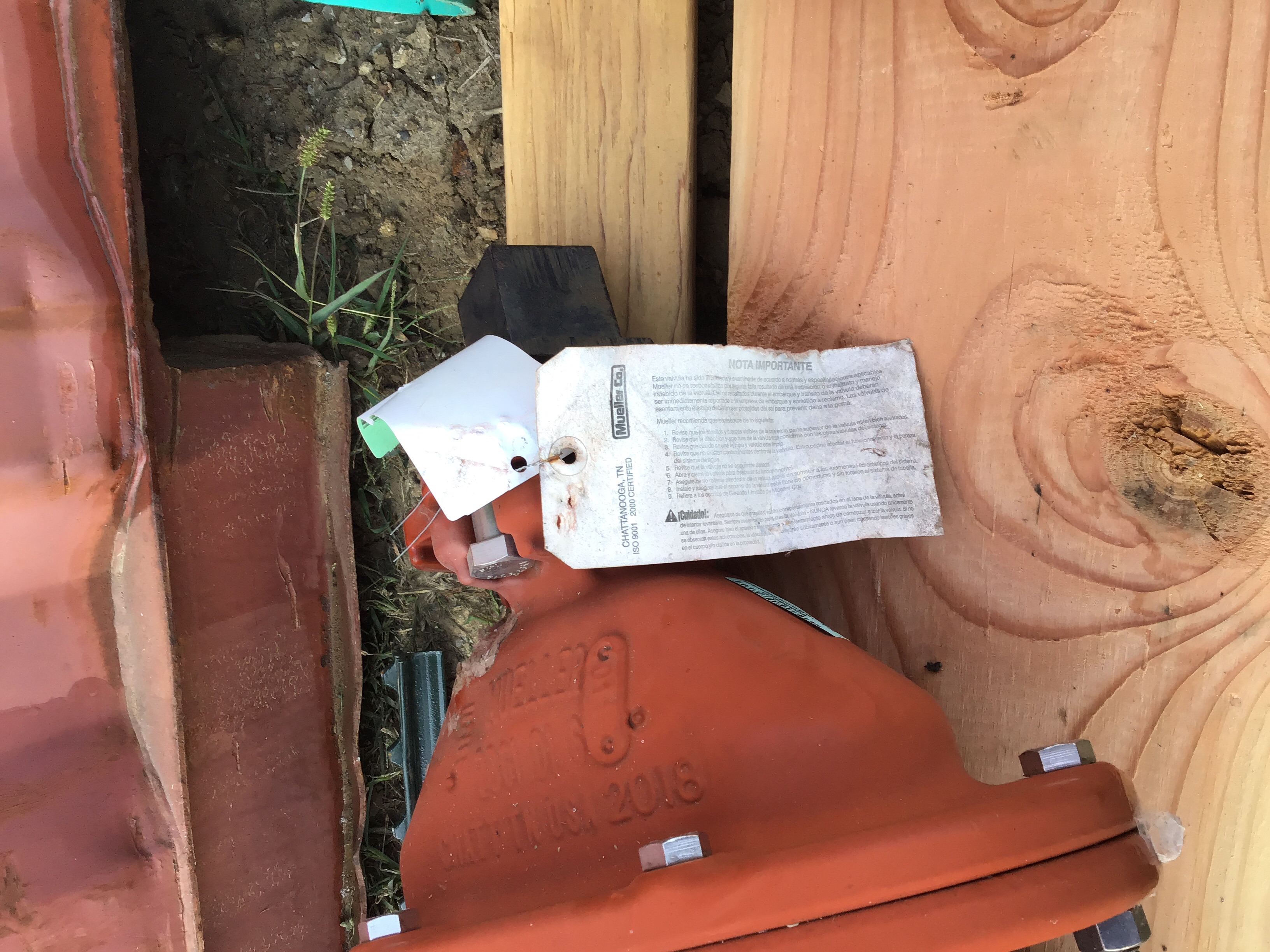

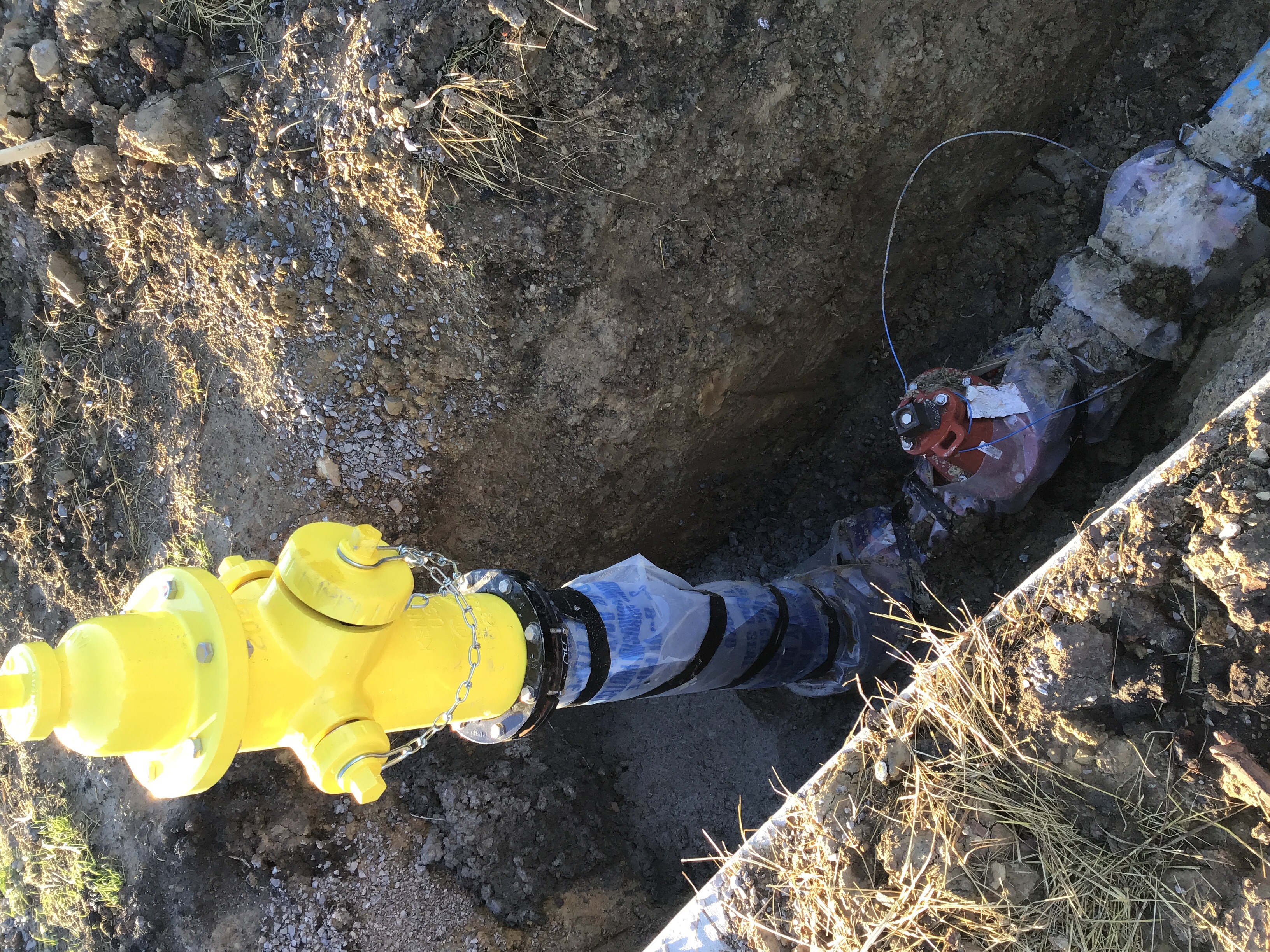

09/29/2020 Hydrant install.jpg
09/29/2020 Letter INSPECTION SUMMARY
10/06/2020 Pryor Water line tie in.jpg
10/06/2020 Pryor water line tie in.jpg0
10/06/2020 Pryor Rd water tie in.jpg
10/06/2020 Letter INSPECTION SUMMARY

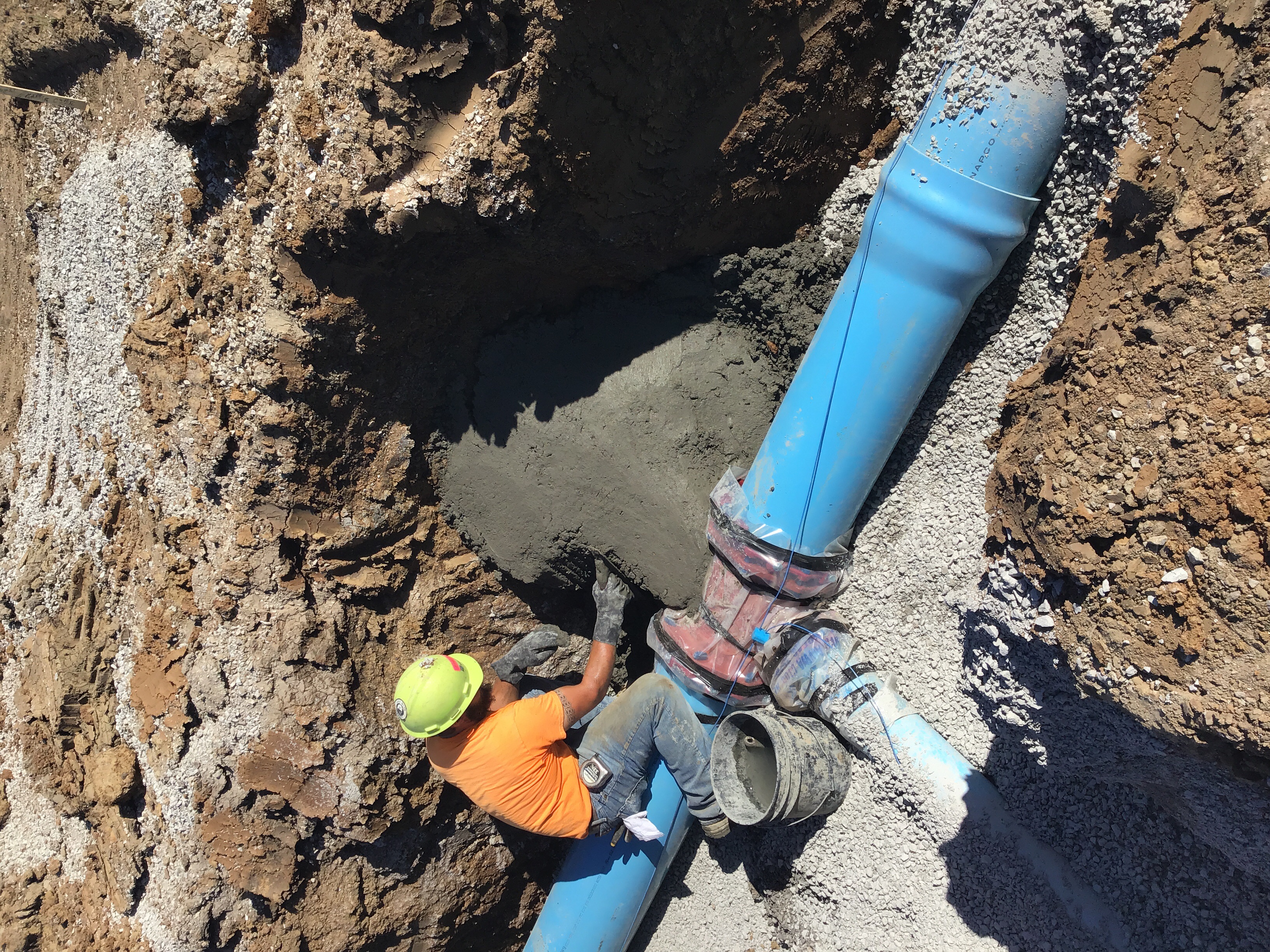

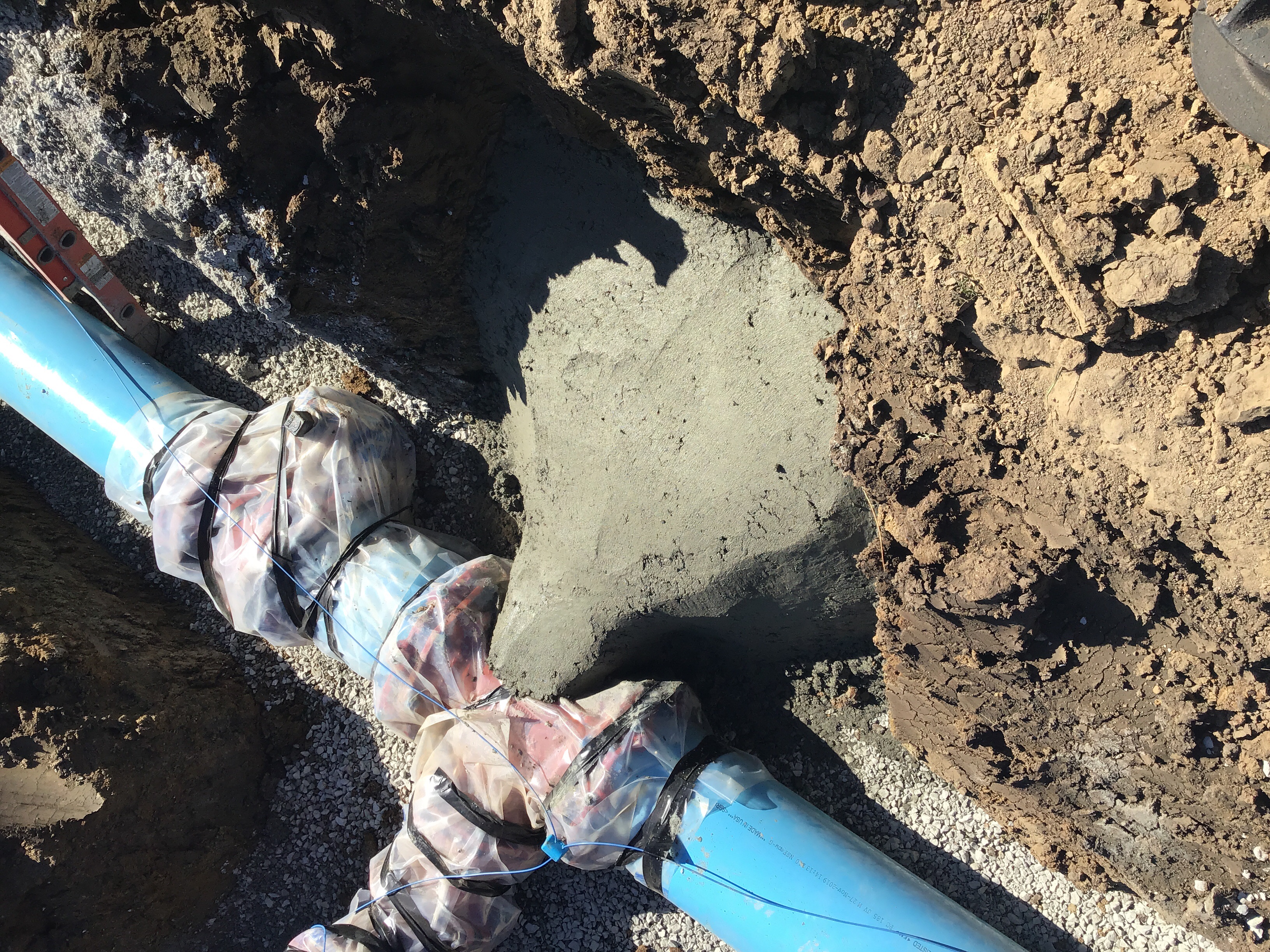

10/07/2020 Pryor Rd water tie in thrust block.jpg

10/07/2020 Pryor rd water line concrete patch.jpg
10/07/2020 Letter INSPECTION SUMMARY
10/13/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter DE-Daily Inspection Summary
10/20/2020 Letter DE-Daily Inspection Summary
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/26/2020 Letter INSPECTION SUMMARY
10/26/2020 Letter DE-Daily Inspection Summary
10/26/2020 Letter INSPECTION SUMMARY
10/27/2020 Letter INSPECTION SUMMARY
10/28/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 WO#1J02524 - City of Lees Summit Day 1 Water Reoprt.pdf
11/02/2020 WO#1J02524 - City of Lees Summit day 2 water report .pdf
10/24/2020 Letter DE-Daily Inspection Summary
01/15/2021 WATER ASBUILTS
01/15/2021 SANITARY ASBUILTS
01/15/2021 STREET AND STORM ASBUILTS
04/01/2021 FW Reserve at Stoney - Pryor Rd Shoulders
04/01/2021 permit signed
04/01/2021 permit
04/01/2021 Stoney Creek 4th Pryor Rd TC Plan
05/26/2021 RESERVE AT STONEY CREEK MDP 5-26-2021
07/01/2021 Letter DE-Certificate of Substantial Completion Multiple Lot
07/01/2021 Letter DE-Punch List
09/30/2021 Stoney Creek Reserve 4th Maint Bond
03/09/2022 Receipt Receipt for transaction: 2022-001285
03/09/2022 Receipt Receipt for transaction: 2022-001286
03/14/2022 Receipt Receipt for transaction:2022-001381
02/16/2023 Stoney Creek 4th Plats Final Affidavits
02/17/2023 Letter DE-Certificate of Final Acceptance (Commercial)
02/17/2023 Reserve at Stoney Creek 4th Plat Subdivision Improvements Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
