Summary

PRSITE20193328
Development - Site
Final Acceptance
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
FULL SITE DEVELOPMENT
11/12/2019
12/16/2019
08/18/2022
Locations
Contacts
CENTRIC CONSTRUCTION GROUP, Address:520 W PENNWAY STE 100, Phone:(816) 389-8300
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 11/12/2019 12/13/2019
Joe Starlin
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $276.30 $276.30 Paid 12/12/2019
91100C9-Water Insp Fee $1,902.75 $1,902.75 Paid 12/12/2019
9110072-Water Test Fee $200.00 $200.00 Paid 12/12/2019
9110068-Storm Fee $529.50 $529.50 Paid 12/12/2019
9110081-Paved Surface Inspection Fee $8,865.95 $8,865.95 Paid 12/12/2019
$8,865.93
9110071-Site Grading Fee $1,275.00 $1,275.00 Paid 12/12/2019
8331401-Water Tap Fee $46,360.00 $46,360.00 Paid 12/20/2019
8350015-Water Meter Fee $6,092.41 $6,092.41 Paid 12/20/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water Line - Construction Inspection Partial 12/23/2019 at 9:20 AM 12/23/2019
Misc
Informational
12/23/2019
The contractor installed approximately 100 ft/5 sticks of 8" pipe. The contractor connected to the vavle and installed the pipe with tracer wire are also installing the water tape. The contractor also asked about a thrust block on the 45 degree bend and I told him they needed a thrust block and also needs plastic wrap around the fittings. They may work tomorrow so I let them know not to cover anything up until thursday when we will be back from our Christmas Break.
Water Line - Construction Inspection Partial 12/26/2019 12/30/2019
Misc
Informational
12/30/2019
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Water Line - Construction Inspection Partial 01/02/2020
Misc
Informational
12/30/2019
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/02/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Water Line - Construction Inspection Partial 1/3/2020 01/03/2020
Misc
Informational
01/02/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/02/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/03/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Water Line - Construction Inspection Partial 01/03/2020
Misc
Informational
01/03/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/03/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/03/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
01/03/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Water Line - Construction Inspection Partial 1/6/2020 01/06/2020
Misc
Informational
01/03/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/03/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/03/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
01/03/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
01/06/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Water Line - Construction Inspection Partial 1/7/2020 01/07/2020
Misc
Informational
01/06/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/06/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/06/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
01/06/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
01/06/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
01/07/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Water Line - Hydrostatic Test Passed 1/9/2020 01/09/2020
Misc
Informational
01/09/2020
1-9-20 10:41am The line is under pressure at 200 and has held for 1 hour.
Misc
Informational
01/09/2020
1-9-20 10:41am The line is under pressure at 200 and has held for 1 hour. The waterline has held for over 2 hours at 200 psi.
Sanitary Sewer Construction Inspection Partial 1/9/2020 01/09/2020
Misc
Informational
01/09/2020

1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Sanitary Sewer Construction Inspection Partial 12/20/2019 01/13/2020
Misc
Informational
01/13/2020
1-13-20 1:47pm They have installed the clean out and a forty five. They have 14ft installed after the 45. They are placing tracer wire as they go. The pipe is SDR26.
Water Line - Construction Inspection Partial 1/14/2020 01/14/2020
Misc
Informational
01/07/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/07/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/07/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
01/07/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
01/07/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
01/07/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Misc
Informational
01/14/2020
1-14-20 10:20am With the water line complete at 9am we started flushing out the chlorine. 11:30am They have flushed the chlorine out and we will pull samples tomorrow.
Water Line - Coliform Test 1 Partial 1/15/2020 01/15/2020
Misc
Informational
01/15/2020
1-15-20 They pulled samples from the fire line in the building and from the end of the main. I am taking them to Keystone Lab. 10:30am The water samples have been dropped off at Keystone Lab. 11:00am I am back on site.
Sanitary Sewer Construction Inspection Partial 1/15/2020 01/15/2020
Misc
Informational
01/13/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
01/15/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
01/15/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Water Line - Coliform Test 1 Passed 1/18/2020 01/21/2020
Misc
Informational
01/15/2020
1-15-20 They pulled samples from the fire line in the building and from the end of the main. I am taking them to Keystone Lab. 10:30am The water samples have been dropped off at Keystone Lab. 11:00am I am back on site.

Water Line - Thrust Restraint Passed 01/21/2020
Water Line - Fire Hydrant Passed 01/21/2020
Sanitary Sewer Construction Inspection Partial 1/21/2020 01/21/2020
Misc
Informational
01/15/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
01/15/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
01/15/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
01/21/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
01/21/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Site Visit Partial 01/23/2020
Misc
Informational
01/23/2020
1-23-20 8:43am 35 degrees with light rain. There is no activity on site at this time for me to inspect.
Sanitary Sewer Construction Inspection Partial 1/27/2020 01/27/2020
Misc
Informational
01/21/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
01/21/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
01/21/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
01/21/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
01/21/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
01/27/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Site Visit Partial 1/30/2020 01/30/2020
Misc
Informational
01/23/2020
1-23-20 8:43am 35 degrees with light rain. There is no activity on site at this time for me to inspect.
Misc
Informational
01/30/2020
1-30-20 10:31am I dropped plans off to Skip the Superintendent of the job.
Site Visit Partial 2/7/2020 02/07/2020
Misc
Informational
01/30/2020
1-23-20 8:43am 35 degrees with light rain. There is no activity on site at this time for me to inspect.
Misc
Informational
01/30/2020
1-30-20 10:31am I dropped plans off to Skip the Superintendent of the job.
Misc
Informational
02/07/2020
2-7-20 10:26am I spoke with Richard for Dirt Movers about the the storm line on the west side of the building. He is wanting to know if the plans are approved. I told him I would look into it. 11:14am I called Richard and informed him that the submittal for the storm line is not approved and they cannot install it at this time.
Sanitary Sewer Construction Inspection Partial 2/10/2020 02/10/2020
Misc
Informational
01/27/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
01/27/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
01/27/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
01/27/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
01/27/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
01/27/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/10/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps.
Water Line - Construction Inspection Partial 2/11/2020 02/11/2020
Misc
Informational
01/14/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
01/14/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
01/14/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
01/14/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
01/14/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
01/14/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Misc
Informational
01/14/2020
1-14-20 10:20am With the water line complete at 9am we started flushing out the chlorine. 11:30am They have flushed the chlorine out and we will pull samples tomorrow.
Misc
Informational
02/11/2020
All samples pulled have passed.
Water Line - Construction Inspection Partial 2/11/2020 02/11/2020
Misc
Informational
02/11/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
02/11/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
02/11/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
02/11/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
02/11/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
02/11/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Misc
Informational
02/11/2020
1-14-20 10:20am With the water line complete at 9am we started flushing out the chlorine. 11:30am They have flushed the chlorine out and we will pull samples tomorrow.
Misc
Informational
02/11/2020
All samples pulled have passed.
Misc
Informational
02/11/2020
2-11-20 11:21am I gave the contractor a detail for the meter pit. They are waiting for the water department to show up for water taps.
Site Visit Partial 02/17/2020
Misc
Informational
02/07/2020
1-23-20 8:43am 35 degrees with light rain. There is no activity on site at this time for me to inspect.
Misc
Informational
02/07/2020
1-30-20 10:31am I dropped plans off to Skip the Superintendent of the job.
Misc
Informational
02/07/2020
2-7-20 10:26am I spoke with Richard for Dirt Movers about the the storm line on the west side of the building. He is wanting to know if the plans are approved. I told him I would look into it. 11:14am I called Richard and informed him that the submittal for the storm line is not approved and they cannot install it at this time.
Misc
Informational
02/17/2020
2-17-20 10:20am I spoke with Dirt Movers and they are setting grease interceptors today. They will not be installing any pipe.
Sanitary Sewer Construction Inspection Partial 2/18/2020 02/18/2020
Misc
Informational
02/10/2020

1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/10/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/10/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/10/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/10/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/10/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/10/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps.
Water Line - Construction Inspection Partial 2/18/2020 02/18/2020
Misc
Informational
02/11/2020

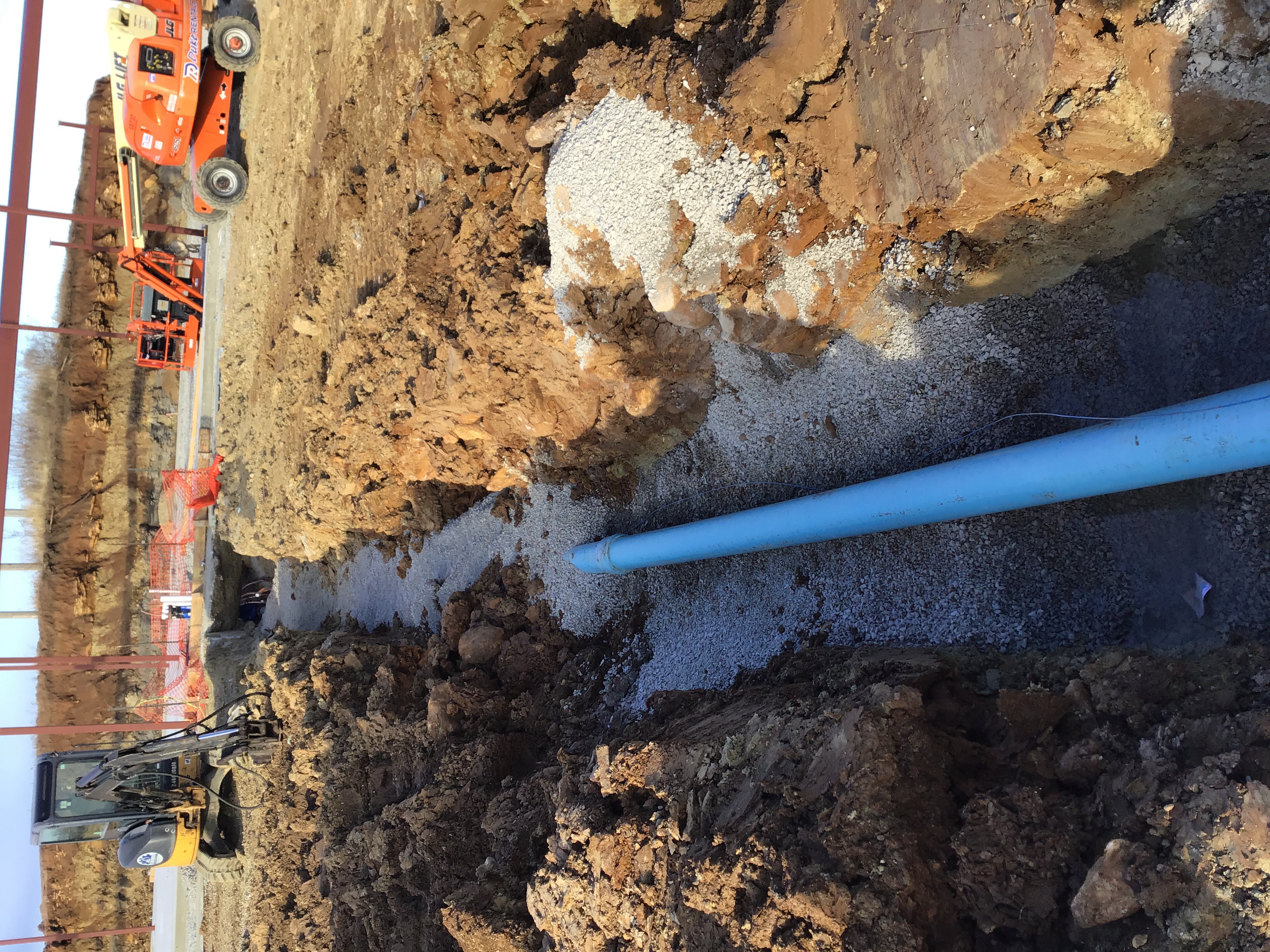

12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
02/11/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
02/11/2020

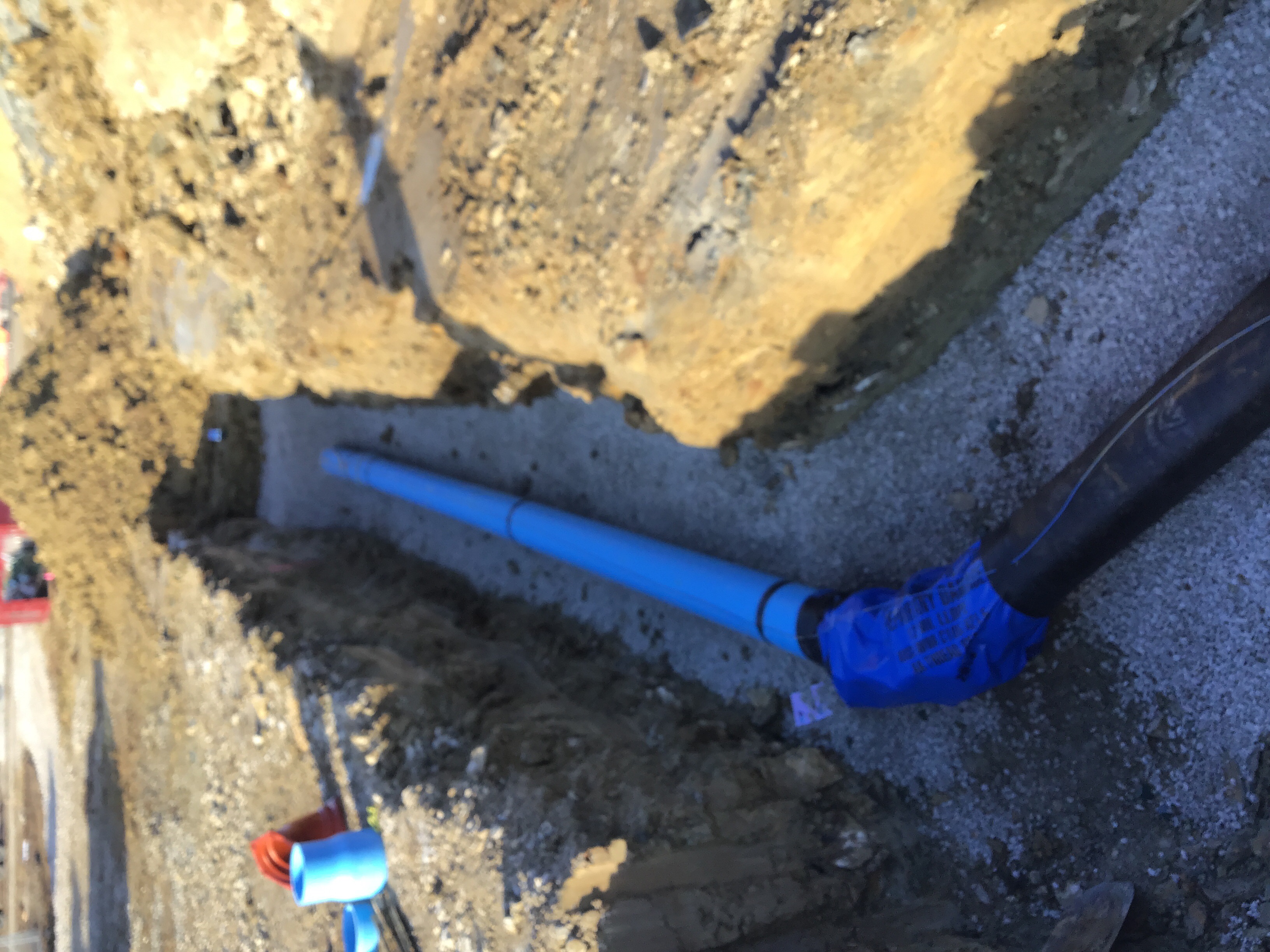

1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
02/11/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
02/11/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
02/11/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Misc
Informational
02/11/2020
1-14-20 10:20am With the water line complete at 9am we started flushing out the chlorine. 11:30am They have flushed the chlorine out and we will pull samples tomorrow.
Misc
Informational
02/11/2020
All samples pulled have passed.
Misc
Informational
02/11/2020

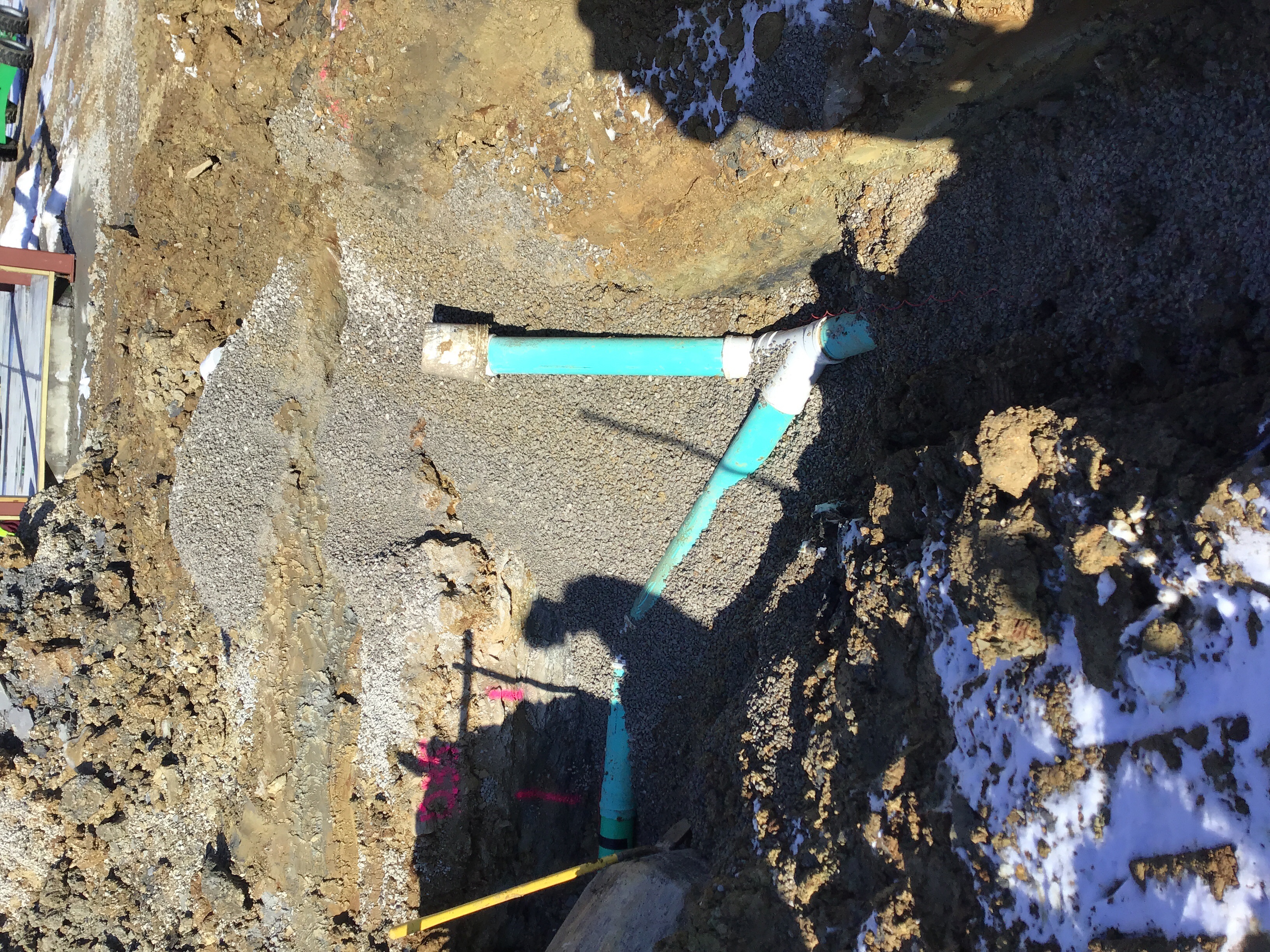

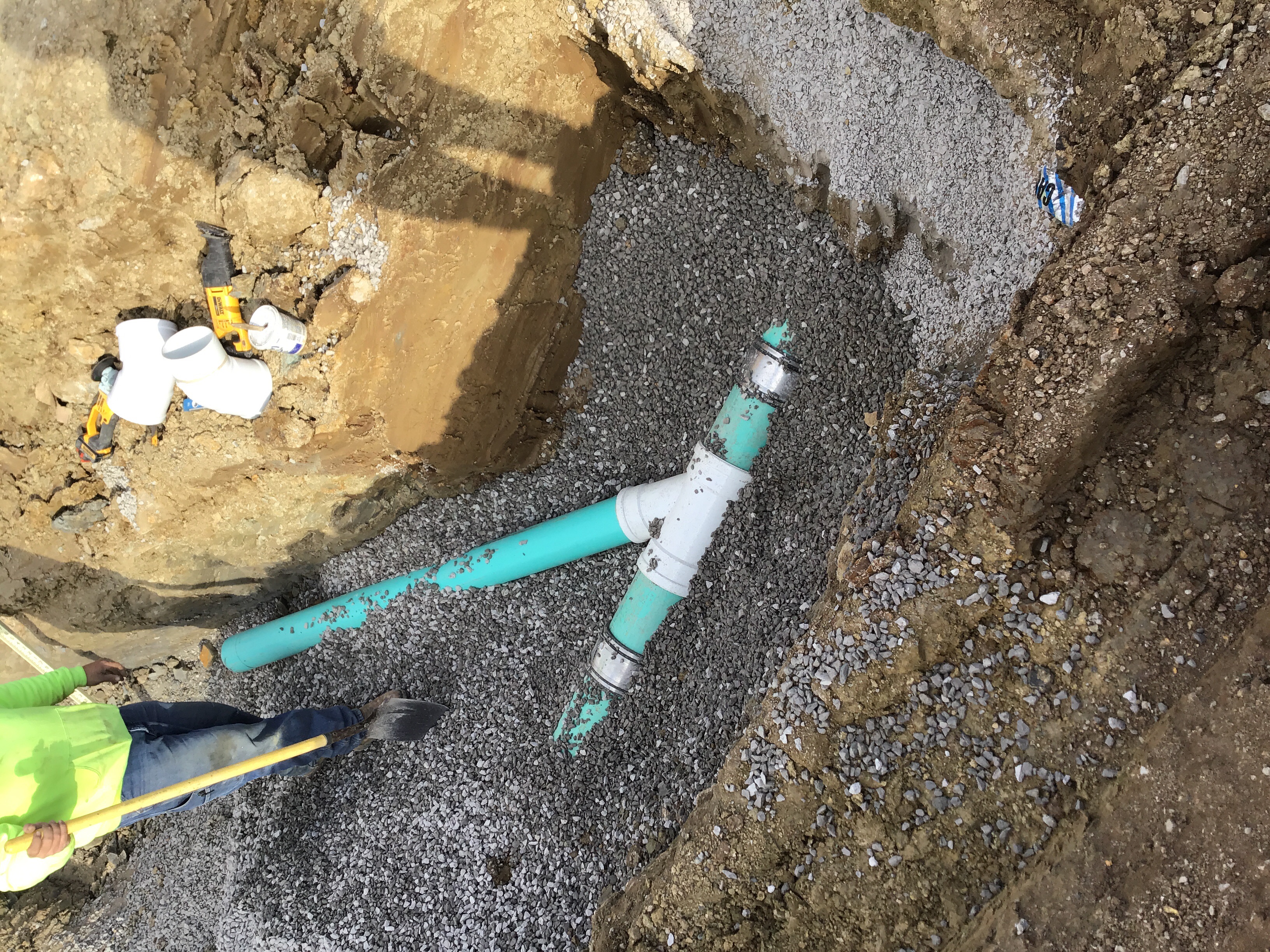

2-11-20 11:21am I gave the contractor a detail for the meter pit. They are waiting for the water department to show up for water taps.
Misc
Informational
02/18/2020
Joe Starlin 02/18/2020 11:11 AM Steve Robbins inspected the meters and pits after they were installed. 2-13-20.
Sanitary Sewer Construction Inspection Partial 2/18/2020 02/18/2020
Misc
Informational
02/18/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/18/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/18/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/18/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/18/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/18/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/18/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps. 2-18-20 2:20pm They have set both grease intercepters and are digging out for more sanitary line.
Sanitary Sewer Construction Inspection Partial 02/20/2020
Misc
Informational
02/18/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/18/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/18/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/18/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/18/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/18/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/18/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps. 2-18-20 2:20pm They have set both grease intercepters and are digging out for more sanitary line.
Misc
Informational
02/20/2020
2-19-20 2:30pm They have 28’ of sanitary line installed with plenty of rock and tracer wire at this time.
Sanitary Sewer Construction Inspection Partial 2/21/2020 02/21/2020
Misc
Informational
02/20/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/20/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/20/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/20/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/20/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/20/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/20/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps. 2-18-20 2:20pm They have set both grease intercepters and are digging out for more sanitary line.
Misc
Informational
02/20/2020
2-19-20 2:30pm They have 28’ of sanitary line installed with plenty of rock and tracer wire at this time.
Misc
Informational
02/21/2020
2-21-20 9:34am They have approximately 42’ of sanitary installed. They have not tied into the second grease trap at this time.
Storm - Pipe Partial 02/21/2020
Misc
Informational
02/21/2020
2-21-20 9:35am They have two roof driains installed on the north side of the building. They had plenty of rock and I told them they could backfill.
Erosion Control Inspection Partial 2/21/2020 02/21/2020
Misc
Informational
02/21/2020
2-21-20 11:12am The erosion controls are in place with a couple small corrections needed. I spoke with the superintendent and he said he will make the corrections.
Sanitary Sewer Construction Inspection Partial 2/24/2020 02/24/2020
Misc
Informational
02/21/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/21/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/21/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/21/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/21/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/21/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/21/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps. 2-18-20 2:20pm They have set both grease intercepters and are digging out for more sanitary line.
Misc
Informational
02/21/2020
2-19-20 2:30pm They have 28’ of sanitary line installed with plenty of rock and tracer wire at this time.
Misc
Informational
02/21/2020
2-21-20 9:34am They have approximately 42’ of sanitary installed. They have not tied into the second grease trap at this time.
Misc
Informational
02/24/2020

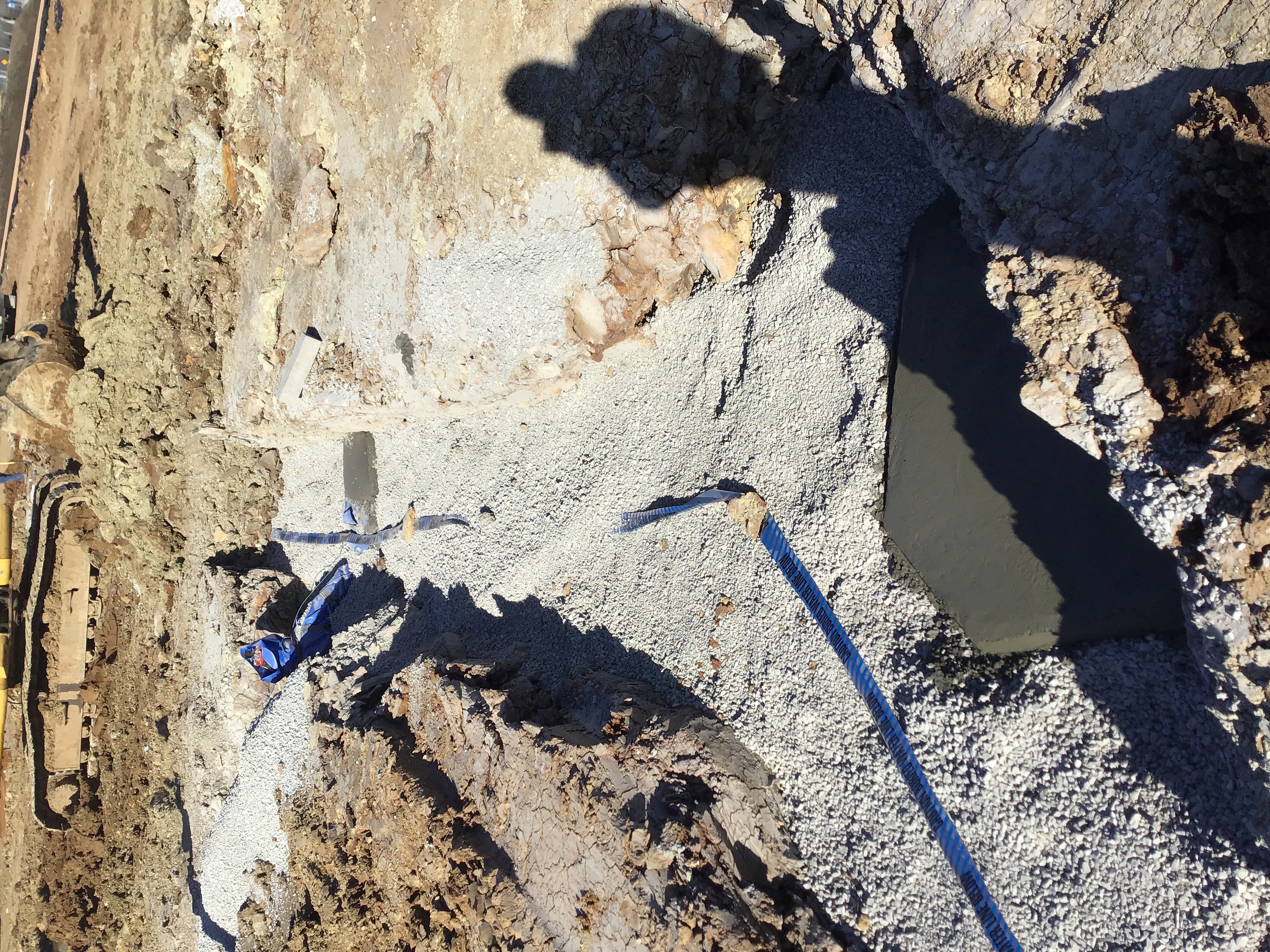

2-24-20 8:55am The sanitary line is tied in to the grease intercepter to the north,I told them they could backfill.
Storm - Pipe Partial 2/25/2020 02/25/2020
Misc
Informational
02/21/2020
2-21-20 9:35am They have two roof driains installed on the north side of the building. They had plenty of rock and I told them they could backfill.
Misc
Informational
02/25/2020
2-25-20 They have poured the collars and invert and are breaking rock for more storm line. They had me sign off on the fire line for sprinkler install.
Erosion Control Inspection Partial 2/25/2020 02/25/2020
Misc
Informational
02/21/2020
2-21-20 11:12am The erosion controls are in place with a couple small corrections needed. I spoke with the superintendent and he said he will make the corrections.
Informational
02/25/2020
2-25-20 The erosion controls on this site are good at this time.
Storm - Pipe Partial 2/28/2020 02/28/2020
Misc
Informational
02/25/2020
2-21-20 9:35am They have two roof driains installed on the north side of the building. They had plenty of rock and I told them they could backfill.
Misc
Informational
02/25/2020
2-25-20 They have poured the collars and invert and are breaking rock for more storm line. They had me sign off on the fire line for sprinkler install.
Misc
Corrective Action Required
02/28/2020
2-28-20 9:26am They have ran all the storm pipe. Steve Robbins performed inspections on 2-26 and 2-27. The roof drain pipe are installed.
Storm - Pipe Partial 3/2/2020 03/02/2020
Misc
Informational
02/28/2020
2-21-20 9:35am They have two roof driains installed on the north side of the building. They had plenty of rock and I told them they could backfill.
Misc
Informational
02/28/2020
2-25-20 They have poured the collars and invert and are breaking rock for more storm line. They had me sign off on the fire line for sprinkler install.
Misc
Corrective Action Required
02/28/2020
2-28-20 9:26am They have ran all the storm pipe. Steve Robbins performed inspections on 2-26 and 2-27. The roof drain pipe are installed.
Misc
Informational
03/02/2020

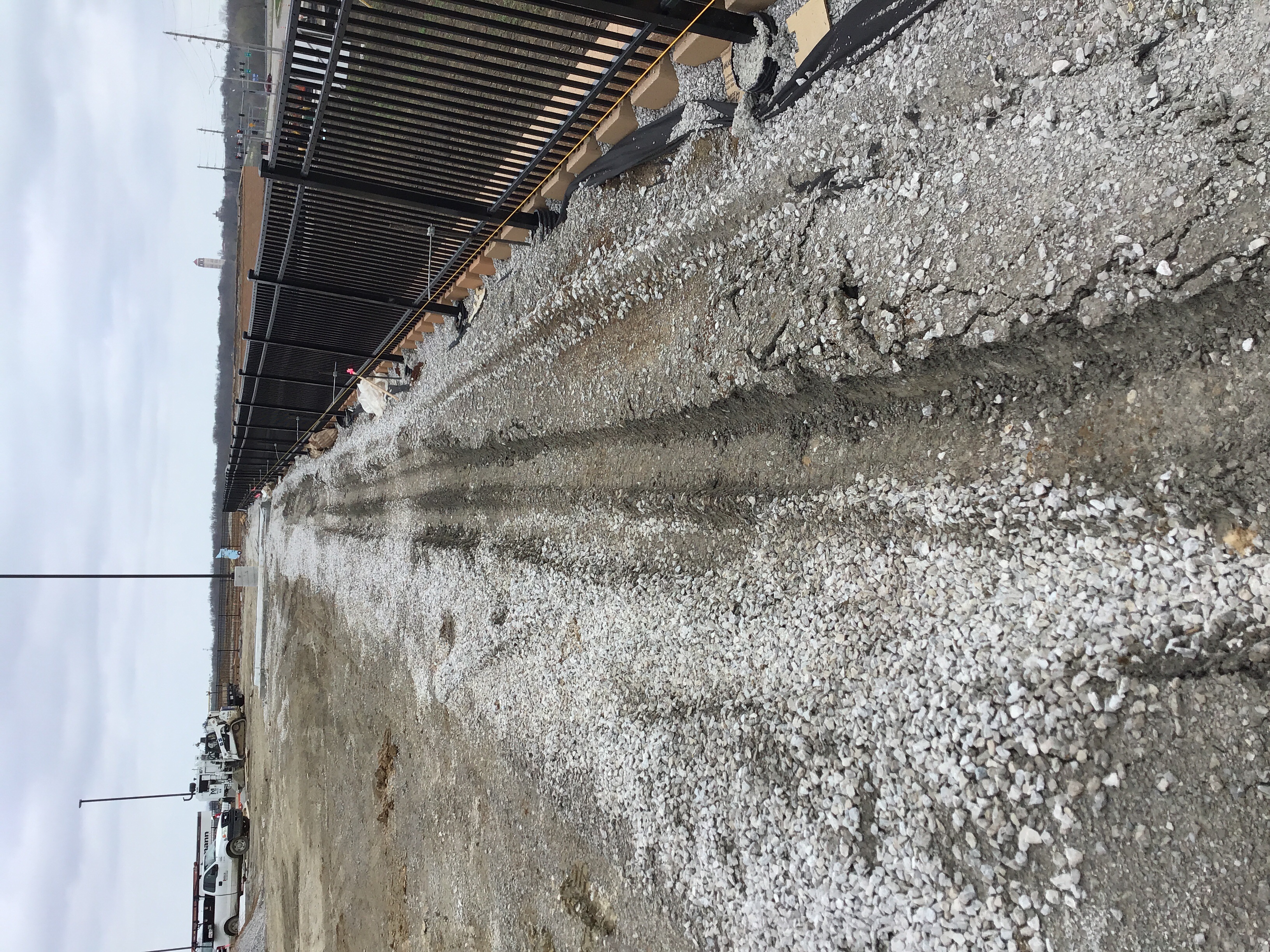

3-2-20 8:20AM Dirt Movers are hammering rock to install more storm pipe. 9:44am They have one stick of 15” storm pipe installed. 1:55pm They have installed a second stick for 15” storm pipe and are breaking rock.
Storm - Pipe Passed 3/3/2020 03/17/2020
Misc
Informational
03/02/2020
2-21-20 9:35am They have two roof driains installed on the north side of the building. They had plenty of rock and I told them they could backfill.
Misc
Informational
03/02/2020
2-25-20 They have poured the collars and invert and are breaking rock for more storm line. They had me sign off on the fire line for sprinkler install.
Misc
Corrective Action Required
03/02/2020
2-28-20 9:26am They have ran all the storm pipe. Steve Robbins performed inspections on 2-26 and 2-27. The roof drain pipe are installed.
Misc
Informational
03/02/2020
3-2-20 8:20AM Dirt Movers are hammering rock to install more storm pipe. 9:44am They have one stick of 15” storm pipe installed. 1:55pm They have installed a second stick for 15” storm pipe and are breaking rock.
Misc
Informational
03/03/2020
3-3-20 9:45am They have connected roof drains into the storm pipe on the west side of the building.
Sanitary Sewer Construction Inspection Passed 03/17/2020
Misc
Informational
02/24/2020
1-9-20 They have cut in a wye and they have one stick on pipe installed at this time. They will be backfilling due to weather.
Misc
Informational
02/24/2020
1-15-20 They have poured the trench check for the sanitary line.
Misc
Informational
02/24/2020
1-15-20 2:40pm They have poured the trench check for the sanitary line. They will be covering it due to weather.
Misc
Informational
02/24/2020
Joe Starlin 01/21/2020 11:24 AM They are breaking rock at this time to install sanitary line.
Misc
Informational
02/24/2020
1-21-20 3:21pm They have dug down to the main and connected the wye and are now digging out for sanitary service line.
Misc
Informational
02/24/2020
1-27-20 Dirt Movers are not on site today to install sanitary line.
Misc
Informational
02/24/2020
2-10-20 8:55am Dirt Movers are digging out for the grease traps. 2-18-20 2:20pm They have set both grease intercepters and are digging out for more sanitary line.
Misc
Informational
02/24/2020
2-19-20 2:30pm They have 28’ of sanitary line installed with plenty of rock and tracer wire at this time.
Misc
Informational
02/24/2020
2-21-20 9:34am They have approximately 42’ of sanitary installed. They have not tied into the second grease trap at this time.
Misc
Informational
02/24/2020
2-24-20 8:55am The sanitary line is tied in to the grease intercepter to the north,I told them they could backfill.
Misc
Informational
03/17/2020
Joe Starlin 03/17/2020 7:25 AM All sanitary line is tied into the grease interceptors. Tracer wire was ran with the sanitary line.
Water Line - Construction Inspection Passed 03/17/2020
Misc
Informational
02/18/2020
12-30-19 10:21am They have installed approximately 60ft of waterline and poured kickers for two forty fives. They are now back to hammering on rock.
Misc
Informational
02/18/2020
1-2-19 2:42pm They have the fire line ran out of the building approximately 30ft. They have approximately 40ft of waterline installed and are getting ready to install a 45 and twenty feet of DIP. They have the right amount of rock and tracer wire.
Misc
Informational
02/18/2020
1-3-2020 9:22am They have installed approximately 40ft of waterline. Along with the DIP pipe.
Misc
Informational
02/18/2020
1-3-2020 2:10pm They have a total of 80ft installed and are backfilling with rock and dirt. Tracer wire is in place and they are laying tracer tape.
Misc
Informational
02/18/2020
1-6-2020 They have installed approximately 60ft of waterline along with a fire hydrant and valve. They will be pouring thrust blocks at a later date.
Misc
Informational
02/18/2020
1-7-2020 9:04am They are installing there last stick of pipe for the waterline. They will be pouring thrust blocks at 12 noon. They have tracer wire in place and plenty of rock. They are backfilling and using tracer tape. 2:17pm They have poured the thrust blocks and will backfill tomorrow.
Misc
Informational
02/18/2020
1-14-20 10:20am With the water line complete at 9am we started flushing out the chlorine. 11:30am They have flushed the chlorine out and we will pull samples tomorrow.
Misc
Informational
02/18/2020
All samples pulled have passed.
Misc
Informational
02/18/2020
2-11-20 11:21am I gave the contractor a detail for the meter pit. They are waiting for the water department to show up for water taps.
Misc
Informational
02/18/2020
Joe Starlin 02/18/2020 11:11 AM Steve Robbins inspected the meters and pits after they were installed. 2-13-20.
Water Line - Coliform Test 2 Passed 1/16/2020 03/20/2020
Misc
Informational
01/16/2020
1-16-20 8:47am They are pulling the second round of samples from two locations. The pipes are frozen so we will try again at 1:30pm. Samples were pulled and have passed.
Site Visit Partial 3/20/2020 03/20/2020
Misc
Informational
02/17/2020
1-23-20 8:43am 35 degrees with light rain. There is no activity on site at this time for me to inspect.
Misc
Informational
02/17/2020

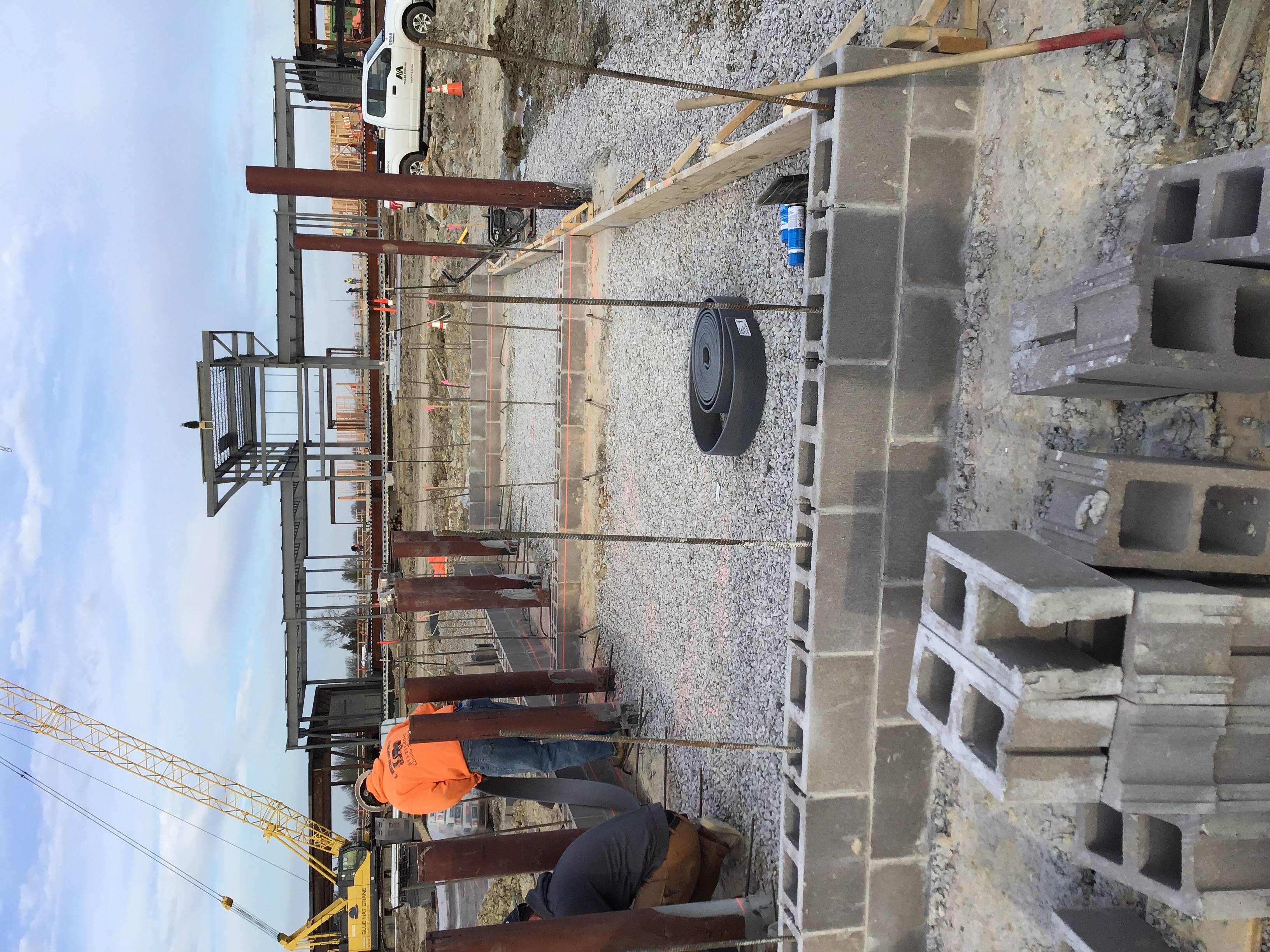

1-30-20 10:31am I dropped plans off to Skip the Superintendent of the job.
Misc
Informational
02/17/2020
2-7-20 10:26am I spoke with Richard for Dirt Movers about the the storm line on the west side of the building. He is wanting to know if the plans are approved. I told him I would look into it. 11:14am I called Richard and informed him that the submittal for the storm line is not approved and they cannot install it at this time.
Misc
Informational
02/17/2020
2-17-20 10:20am I spoke with Dirt Movers and they are setting grease interceptors today. They will not be installing any pipe.
Misc
Informational
03/20/2020
3-20-20 I talked with Skip the superintendent about what is needed for curb placement.
Pavement-Curb Construction Partial 03/21/2020
Misc
Informational
03/21/2020
3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Pavement-Curb Construction Partial 03/23/2020
Misc
Informational
03/21/2020

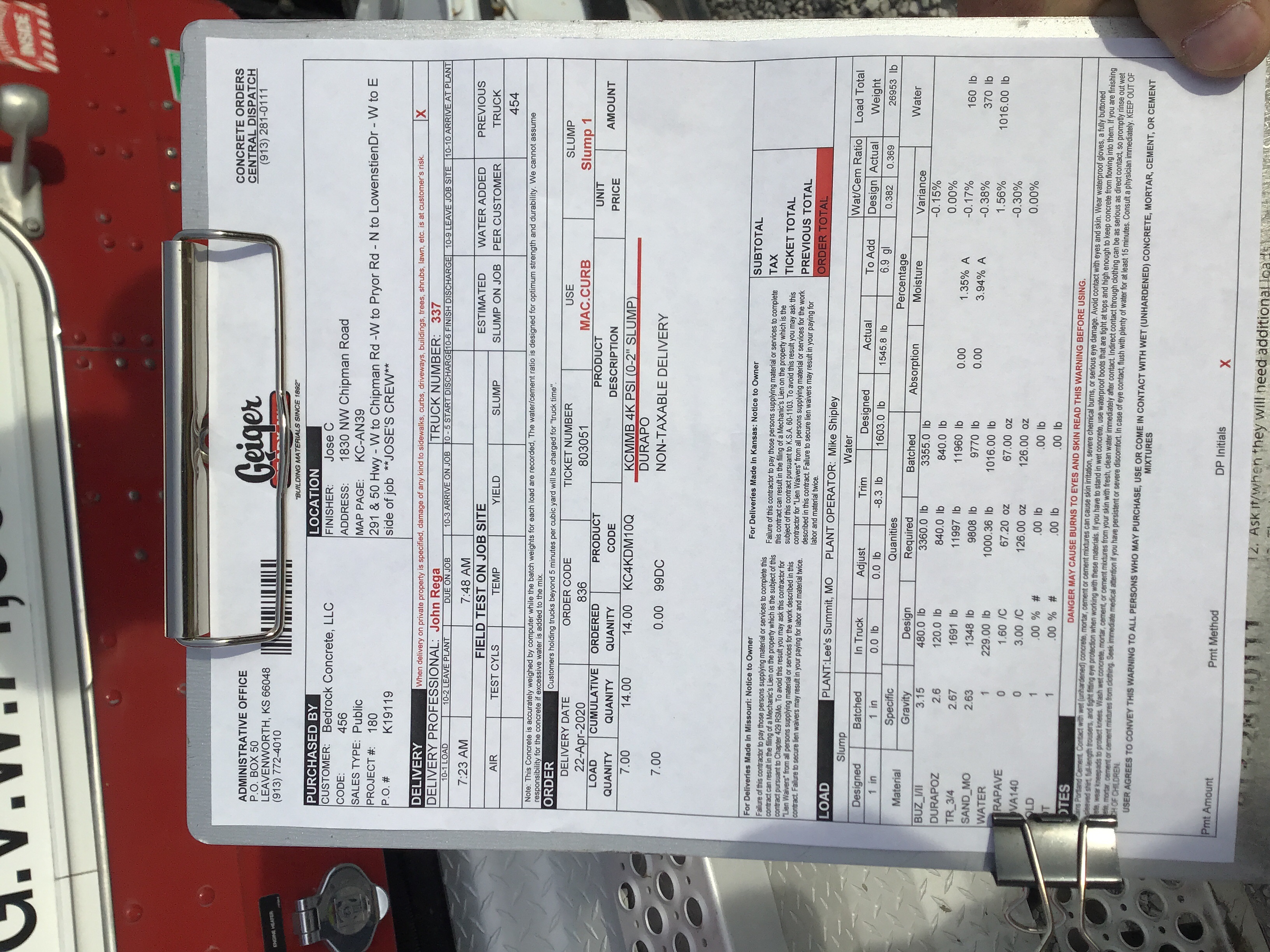

3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Misc
Informational
03/23/2020
3-23-20 9:33am They have all of the curb for the islands on the east side of the building poured.
Sidewalk Inspection Partial 3/31/2020 03/31/2020
Misc
Informational
03/31/2020
3-31-20 1:18pm They have the forms set and wire mess with aggregate per plan. I informed them to stay ADA compliant.
Curb - Proof Roll Failed 4/7/2020 04/07/2020
Misc
Informational
04/07/2020
4-7-20 10:26am The intire curb line on the west side of the building has failed.
Curb - Proof Roll Partial 4/20/2020 04/20/2020
Misc
Informational
04/07/2020
4-7-20 10:26am The intire curb line on the west side of the building has failed.
Misc
Informational
04/20/2020
4-20-20 12:40pm We are proof rolling the curb for the outside perimeter of the site. 1:17pm The east side of the site failed. The west side has passed with the exception of the perimeter south of the inlet. South of the inlet pumped and will need corrected. CFS agreed with the out come of the proof roll.
Water Line - Construction Inspection Partial 4/20/2020 04/20/2020
Misc
Informational
04/20/2020
2-20-20 3:42pm They adjusted the meters in the pits.
Pavement-Curb Construction Partial 4/22/2020 04/22/2020
Misc
Informational
03/23/2020
3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Misc
Informational
03/23/2020
3-23-20 9:33am They have all of the curb for the islands on the east side of the building poured. 8:54AM They have all machine pouring done and are working on hand pours now. They have covered the curb with plastic due to rain.
Pavement-Curb Construction Partial 4/23/2020 04/23/2020
Misc
Informational
04/22/2020
3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Misc
Informational
04/22/2020
3-23-20 9:33am They have all of the curb for the islands on the east side of the building poured. 8:54AM They have all machine pouring done and are working on hand pours now. They have covered the curb with plastic due to rain. They have finished the islands and are working on the sidewalk on west side.
Pavement-Curb Construction Partial 04/27/2020
Misc
Informational
04/23/2020
3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Misc
Informational
04/23/2020
3-23-20 9:33am They have all of the curb for the islands on the east side of the building poured. 8:54AM They have all machine pouring done and are working on hand pours now. They have covered the curb with plastic due to rain. They have finished the islands and are working on the sidewalk on west side. 4-27-20 10:44am They have poured all the curb on the west side of the building and are wrecking forms.
Proof roll parking lot Partial 04/30/2020
Misc
Informational
04/30/2020
4-29-20 John Jackson inspected the proof roll on the west side of the site for the parking lot. He has informed me that it passed with no issues.
Curb - Proof Roll Partial 05/01/2020
Misc
Informational
04/20/2020
4-7-20 10:26am The intire curb line on the west side of the building has failed.
Misc
Informational
04/20/2020
4-20-20 12:40pm We are proof rolling the curb for the outside perimeter of the site. 1:17pm The east side of the site failed. The west side has passed with the exception of the perimeter south of the inlet. South of the inlet pumped and will need corrected. CFS agreed with the out come of the proof roll.
Misc
Informational
05/01/2020
5-1-20 10:49am We proof rolled the East side and NE side of the site for curb. It has passed with Two corrections to be made. Mike with CFS agrees with the out come and will over see the corrections. They plan on pouring curb on 5-2-20. I informed them of overtime fees and the superintendent was fine with that.
Pavement-Surface Partial 4/30/2020 05/01/2020
Misc
Informational
04/30/2020
4-30-20 8:18am Thorne & Sons Asphalt are laying the Type 2 base on the west side of the parking lot. CFS will be doing all of the testing. 5-1-20 All base asphalt is in on the East side of the site.
Pavement-Curb Construction Partial 05/04/2020
Misc
Informational

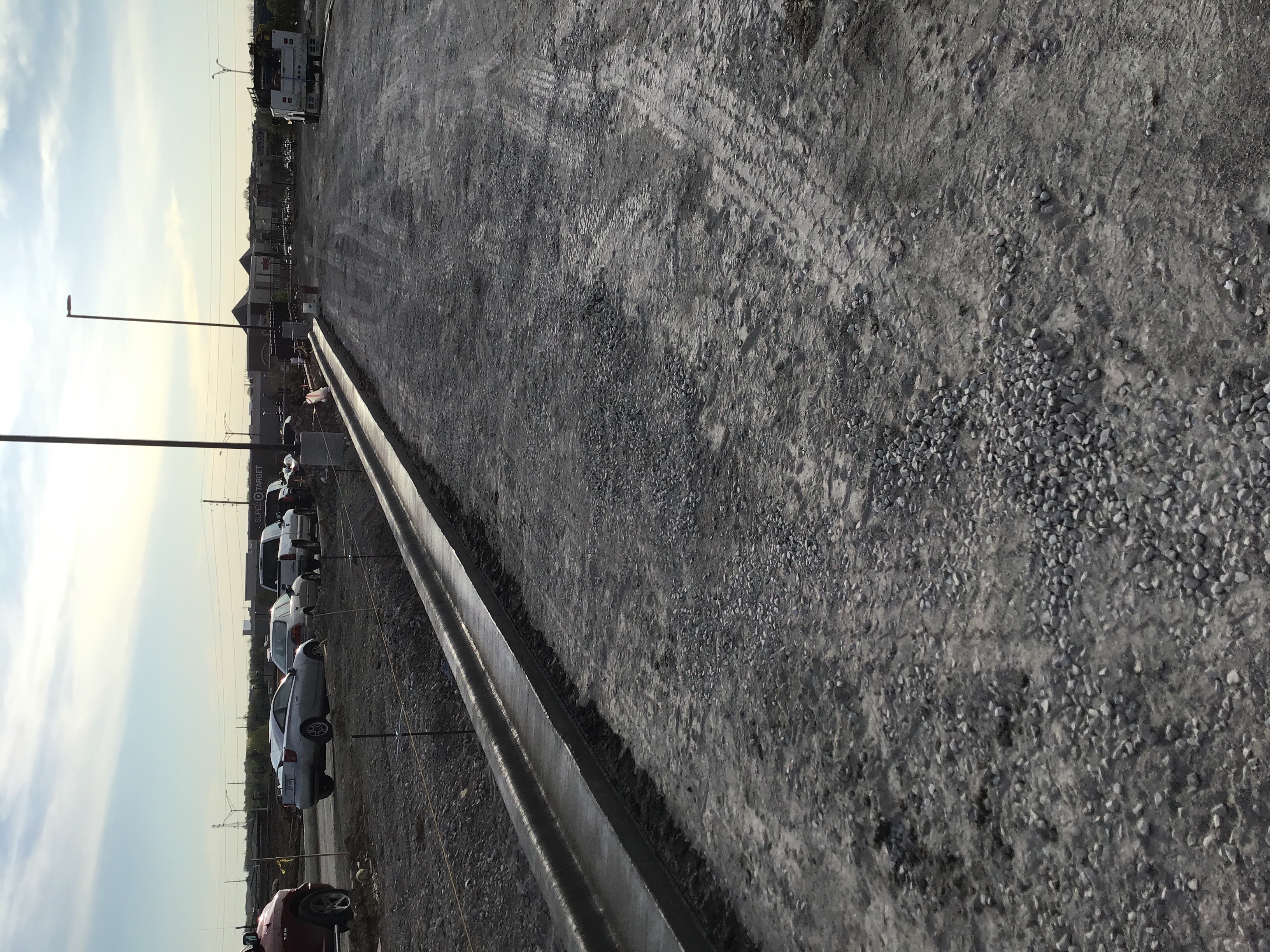

04/27/2020
3-21-20 Bedrock concrete have set up curb for four islands in the parking lot. They are getting concrete at 9:30am 4K mix and will be using white cure. I have collected the concrete ticket that calls out 4K mix. They have one island left to pour.
Misc
Informational
04/27/2020
3-23-20 9:33am They have all of the curb for the islands on the east side of the building poured. 8:54AM They have all machine pouring done and are working on hand pours now. They have covered the curb with plastic due to rain. They have finished the islands and are working on the sidewalk on west side. 4-27-20 10:44am They have poured all the curb on the west side of the building and are wrecking forms. 5-4-20 8:23am They poured the curb on the east side of the site on Saturday. John Jackson was the inspector. They are now wrecking the forms and cleaning up. Rain is moving in.
Proof roll parking lot Partial 05/06/2020
Misc
Informational
04/30/2020
4-29-20 John Jackson inspected the proof roll on the west side of the site for the parking lot. He has informed me that it passed with no issues. 5-6-20 12:55pm We proof rolled the parking lot on the east side of the site. The majority passed with some corrections needing made. CFS will over see the corrections and I will inspect again after the corrections are made.
Pavement-Surface Partial 5/7/2020 05/07/2020
Misc
Informational
05/01/2020
4-30-20 8:18am Thorne & Sons Asphalt are laying the Type 2 base on the west side of the parking lot. CFS will be doing all of the testing. 5-1-20 All base asphalt is in on the West side of the site. 5-7-20 8:33am They are laying asphalt on the NE side of the site and working there way to the East side of the site. CFS is on site for testing. They finished laying the base right as the rain started moving in.
Site Visit Partial 06/18/2020
Misc
Informational
06/18/2020
6-18-20 2:40pm I met with Brad Wehde to look at his sidewalk on the west side of the site. I will need to talk to Steve Robbins on how to proceed. They did not install ADA domes and the walk is holding water.
Street - Surface Course Passed 5/14/2020 10/27/2020
Misc
Informational
05/14/2020
5-13-20 They are laying the surface corse at lot 10 CFS is on site for testing.
ESC - (Vegetation/Ground Cover) Passed 08/18/2022
Documents & Images
Date Uploaded File Type Document Name
12/12/2019 Receipt Receipt for transaction: 2019-007704
12/13/2019 Letter DE-Permit
12/16/2019 PERMIT LOT 10 SWP
12/23/2019 Letter DE-Daily Inspection Summary
12/30/2019 Letter INSPECTION SUMMARY
01/02/2020 Letter INSPECTION SUMMARY
01/03/2020 Waterline
01/03/2020 Letter INSPECTION SUMMARY
01/07/2020 Waterline for hydrant
01/07/2020 Thrust block
01/07/2020 Letter INSPECTION SUMMARY
01/09/2020 Service line WYE
01/13/2020 Sanitary line
01/13/2020 Sanitary line clean out
01/15/2020 Trench check
01/23/2020 water samples 1 lot 10
01/23/2020 samples 2 lot 10
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter DE-Permit
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/20/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/25/2020 Letter INSPECTION SUMMARY
03/02/2020 Letter INSPECTION SUMMARY
03/17/2020 Letter INSPECTION SUMMARY
03/20/2020 Letter INSPECTION SUMMARY
03/20/2020 Letter INSPECTION SUMMARY
03/20/2020 Letter INSPECTION SUMMARY
03/20/2020 Letter INSPECTION SUMMARY
03/21/2020 Island
03/21/2020 Island
03/31/2020 Trash enclosure
03/31/2020 Letter INSPECTION SUMMARY
04/03/2020 Approved - Lot 10 SWP Pvmt Waiver
04/07/2020 Failed proof roll curb line
04/07/2020 Letter INSPECTION SUMMARY
04/20/2020 Letter INSPECTION SUMMARY
04/20/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/27/2020 Letter INSPECTION SUMMARY
04/30/2020 Letter INSPECTION SUMMARY
05/01/2020 Proof roll ticket
05/01/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/04/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY
10/29/2020 Letter INSPECTION SUMMARY
10/29/2020 Letter DE-Punch List
10/29/2020 Letter DE-Certificate of Final Acceptance (Commercial)
10/29/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
03/23/2020 Letter INSPECTION SUMMARY
03/21/2020 Letter INSPECTION SUMMARY
02/28/2020 Letter INSPECTION SUMMARY
02/25/2020 Letter INSPECTION SUMMARY
02/24/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter DE-Daily Inspection Summary
02/18/2020 Letter INSPECTION SUMMARY
02/07/2020 Letter INSPECTION SUMMARY
01/21/2020 WO#1B90227 - City of Lees Summit Day 2
01/21/2020 WO#1B90176 - City of Lees Summit
12/20/2019 Receipt Receipt for transaction: 2019-007792
04/22/2020 Concrete ticket
04/22/2020 North curb
08/17/2022 Lot 10 Streets of West Pryor Final Acceptance
06/18/2020 Letter INSPECTION SUMMARY
08/17/2022 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
