Summary


PRSITE20191519
Development - Site
Final Acceptance
TOWNSEND SUMMIT LLC
DEVELOPMENT COMPLETE
Private infrustruction. Includes grading, storm water and streets.
06/11/2019
07/08/2019
11/17/2020
Locations
Contacts
TOWNSEND SUMMIT LLC, Address:1311 MCCORMICK RD STE 470, Phone:(303) 947-2044
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/11/2019 06/11/2019
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110068-Storm Fee $2,550.54 $2,550.54 Paid 06/21/2019
9110081-Paved Surface Inspection Fee $10,644.23 $10,644.23 Paid 06/21/2019
$10,644.24
9110071-Site Grading Fee $8,079.87 $8,079.87 Paid 06/21/2019
9110068-Storm Fee $1,924.35 $1,924.35 Paid 01/15/2020
$4,474.88
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $25.00 $0.00 $25.00 Not Paid



(None of the fees owing can be paid online)
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Storm - Pipe Partial 8/5/2019 08/05/2019
Misc
Informational
08/05/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Storm - Pipe Partial 8/6/2019 08/06/2019
Misc
Informational
08/05/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/06/2019
7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Storm - Pipe Partial 8/8/2019 08/09/2019
Misc
Informational
08/06/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/06/2019
7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Misc
Informational
08/08/2019
8-8-19 E-4 is set and pipe is ran. They will be pouring collars at 10am. They are working on installing new curb inlet along Ward. The collars and inverts are poured for E-1 through E-4. The curb inlet has been installed.
Storm - Pipe Partial 8/13/2019 08/13/2019
Misc
Informational
08/09/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/09/2019
7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Misc
Informational
08/09/2019
8-8-19 E-4 is set and pipe is ran. They will be pouring collars at 10am. They are working on installing new curb inlet along Ward. The collars and inverts are poured for E-1 through E-4. The curb inlet has been installed.
Misc
Informational
08/09/2019
8-9-19 9:05am They have set box A-1 and are now setting D-2. 1:10pm 120 feet of storm pipe has been installed. They are digging through shell.
Misc
Informational
08/12/2019
8-12-19 They are cutting into the existing box to run storm pipe from A-1 into it. They got 200 foot of storm pipe installed Friday. They are backfilling with watered down shell and will be getting compaction test from Terricon. I told them that the shell needs to be crushed down a little more than what they have at 200 feet from the box. 12:01pm They are getting ready to place A-2 box. 1:56pm A-2 box is placed and they are digging across the road. C-1 is placed and pipe ran. They have two sticks of pipe coming out of A-2 heading for A-3 box. The collars have been poured on A-1 A-2 and C-1.
Storm - Pipe Partial 8/13/2019 08/14/2019
Misc
Informational
08/13/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/13/2019
7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Misc
Informational
08/13/2019
8-8-19 E-4 is set and pipe is ran. They will be pouring collars at 10am. They are working on installing new curb inlet along Ward. The collars and inverts are poured for E-1 through E-4. The curb inlet has been installed.
Misc
Informational
08/13/2019
8-9-19 9:05am They have set box A-1 and are now setting D-2. 1:10pm 120 feet of storm pipe has been installed. They are digging through shell.
Misc
Informational
08/13/2019
8-12-19 They are cutting into the existing box to run storm pipe from A-1 into it. They got 200 foot of storm pipe installed Friday. They are backfilling with watered down shell and will be getting compaction test from Terricon. I told them that the shell needs to be crushed down a little more than what they have at 200 feet from the box. 12:01pm They are getting ready to place A-2 box. 1:56pm A-2 box is placed and they are digging across the road. C-1 is placed and pipe ran. They have two sticks of pipe coming out of A-2 heading for A-3 box. The collars have been poured on A-1 A-2 and C-1.
Misc
Informational
08/13/2019
8-13-19 11:27am They have approximately 120 feet of storm installed working to A-3.
Storm - Pipe Partial 8/15/2019 08/15/2019
Misc
Informational
08/14/2019
8-13-19 11:27am They have approximately 120 feet of storm installed working to A-3.
Misc
Informational
08/14/2019
8-12-19 They are cutting into the existing box to run storm pipe from A-1 into it. They got 200 foot of storm pipe installed Friday. They are backfilling with watered down shell and will be getting compaction test from Terricon. I told them that the shell needs to be crushed down a little more than what they have at 200 feet from the box. 12:01pm They are getting ready to place A-2 box. 1:56pm A-2 box is placed and they are digging across the road. C-1 is placed and pipe ran. They have two sticks of pipe coming out of A-2 heading for A-3 box. The collars have been poured on A-1 A-2 and C-1.
Misc
Informational
08/14/2019
8-9-19 9:05am They have set box A-1 and are now setting D-2. 1:10pm 120 feet of storm pipe has been installed. They are digging through shell.
Misc
Informational
08/14/2019
8-8-19 E-4 is set and pipe is ran. They will be pouring collars at 10am. They are working on installing new curb inlet along Ward. The collars and inverts are poured for E-1 through E-4. The curb inlet has been installed.
Misc
Informational
08/14/2019
7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Misc
Informational
08/14/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/14/2019
8-14-19 9:14am Box A-3 and B-1 are in and they are pouring collars right now. They are installing 15” storm along Chipman as well.
Misc
Informational
08/15/2019
8-15-19 9:15am They are installing storm pipe along Chipman RD. They have 16 feet installed and are close to setting a box F-1. 2:20pm They have installed approximately 25 additional feet and box F-1. They have poured collars and backfilled with rock.
Site Visit Partial 8/21/2019 08/21/2019
Misc
Informational
08/21/2019
8-21-19 11:18am There is no activity on site.
Site Visit Partial 8/22/2019 08/22/2019
Misc
Informational
08/21/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/22/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Site Visit Partial 8/23/2019 08/23/2019
Misc
Informational
08/22/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/22/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/23/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Site Visit Partial 8/26/2019 08/26/2019
Misc
Informational
08/23/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
08/23/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/23/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/26/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Site Visit Partial 8/28/2019 08/29/2019
Misc
Informational
08/26/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
08/26/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/26/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/26/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
08/28/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Site Visit Partial 8/29/2019 08/29/2019
Misc
Informational
08/29/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
08/29/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/29/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/29/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
08/29/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
08/29/2019
8-29-19 There was a operator on site working on grade.
Site Visit Partial 8/30/2019 08/30/2019
Misc
Informational
08/29/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
08/29/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/29/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/29/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
08/29/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
08/29/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
08/30/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Erosion Control Inspection Partial 2/21/2020 08/30/2019
Misc
Informational
08/30/2019

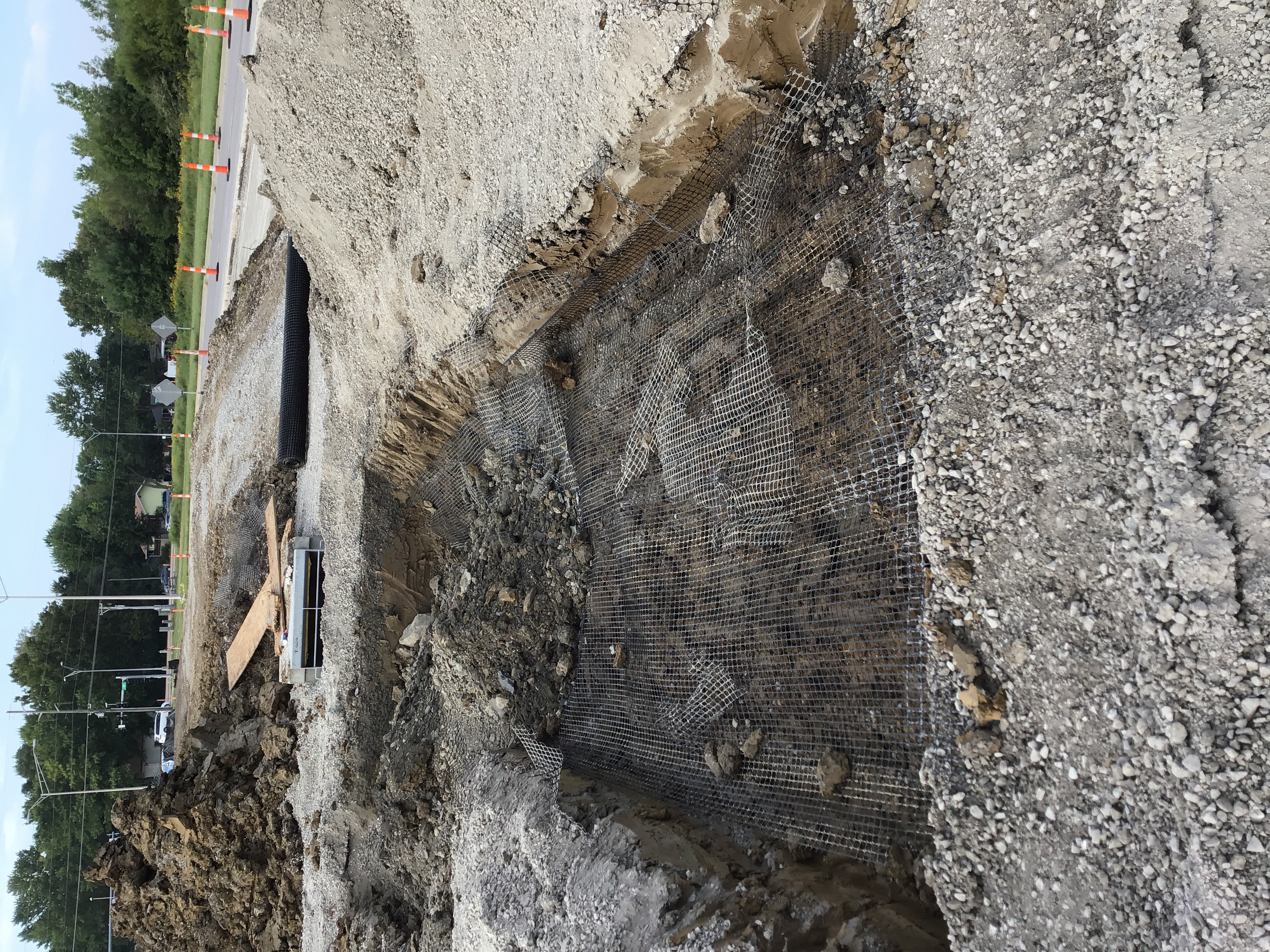

8-30-19 10:00am Rain. All erosion control is in place and working at this time.
Pavement-Stabilized Subgrade Partial 9/4/2019 09/04/2019
Misc
Informational
09/04/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Pavement-Stabilized Subgrade Partial 9/5/2019 09/09/2019
Misc
Informational
09/04/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Pavement-Stabilized Subgrade Partial 9/7/2019 09/09/2019
Misc
Informational
09/09/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Misc
Corrective Action Required
09/09/2019
On 9-7-19 They were cutting grade for the turn lane on Chipman. They will be laying base rock on monday the 9th.
Pavement-Stabilized Subgrade Partial 09/09/2019
Misc
Informational
09/09/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Misc
Corrective Action Required
09/09/2019
On 9-7-19 They were cutting grade for the turn lane on Chipman. They will be laying base rock on monday the 9th.
Misc
Informational
09/09/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/09/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/09/2019
9-9-19 They are working on the grade on the south side along Chipman. I collected base rock tickets from Bill.
Pavement-Stabilized Subgrade Partial 9/10/2019 09/10/2019
Misc
Informational
09/09/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Misc
Corrective Action Required
09/09/2019
On 9-7-19 They were cutting grade for the turn lane on Chipman. They will be laying base rock on monday the 9th.
Misc
Informational
09/09/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/09/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/09/2019
9-9-19 They are working on the grade on the south side along Chipman. I collected base rock tickets from Bill.
Misc
Informational
09/10/2019
9-10-19 2:41pm They are installing base rock in the turning lane on Chipman. The turning lanes on Ward Rd have geogrid and base rock laid. Approximately 400 ton was laid today. They will be trimming base rock later.

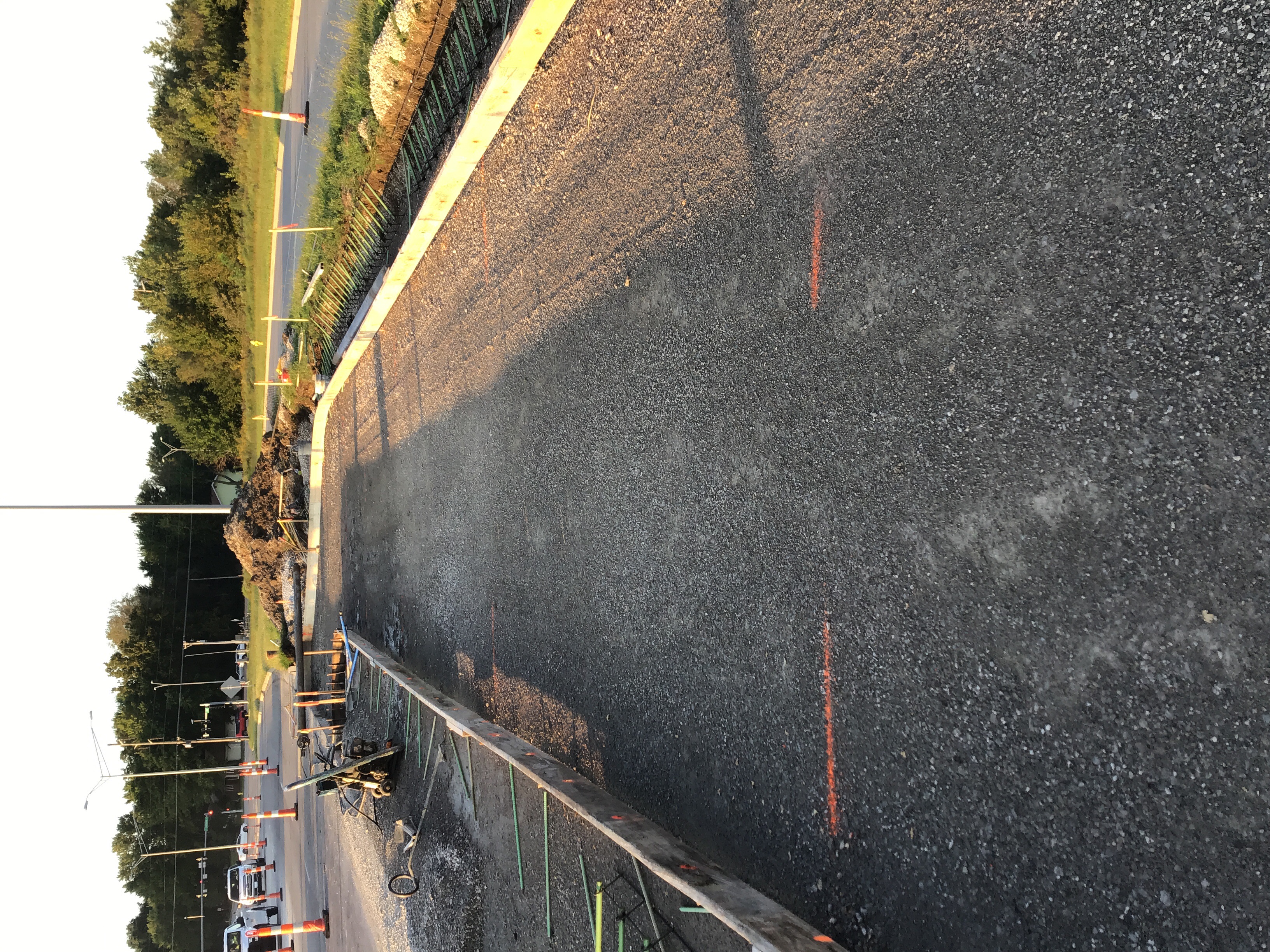

Proof roll parking lot Partial 9/12/2019 09/12/2019
Misc
Informational
09/12/2019

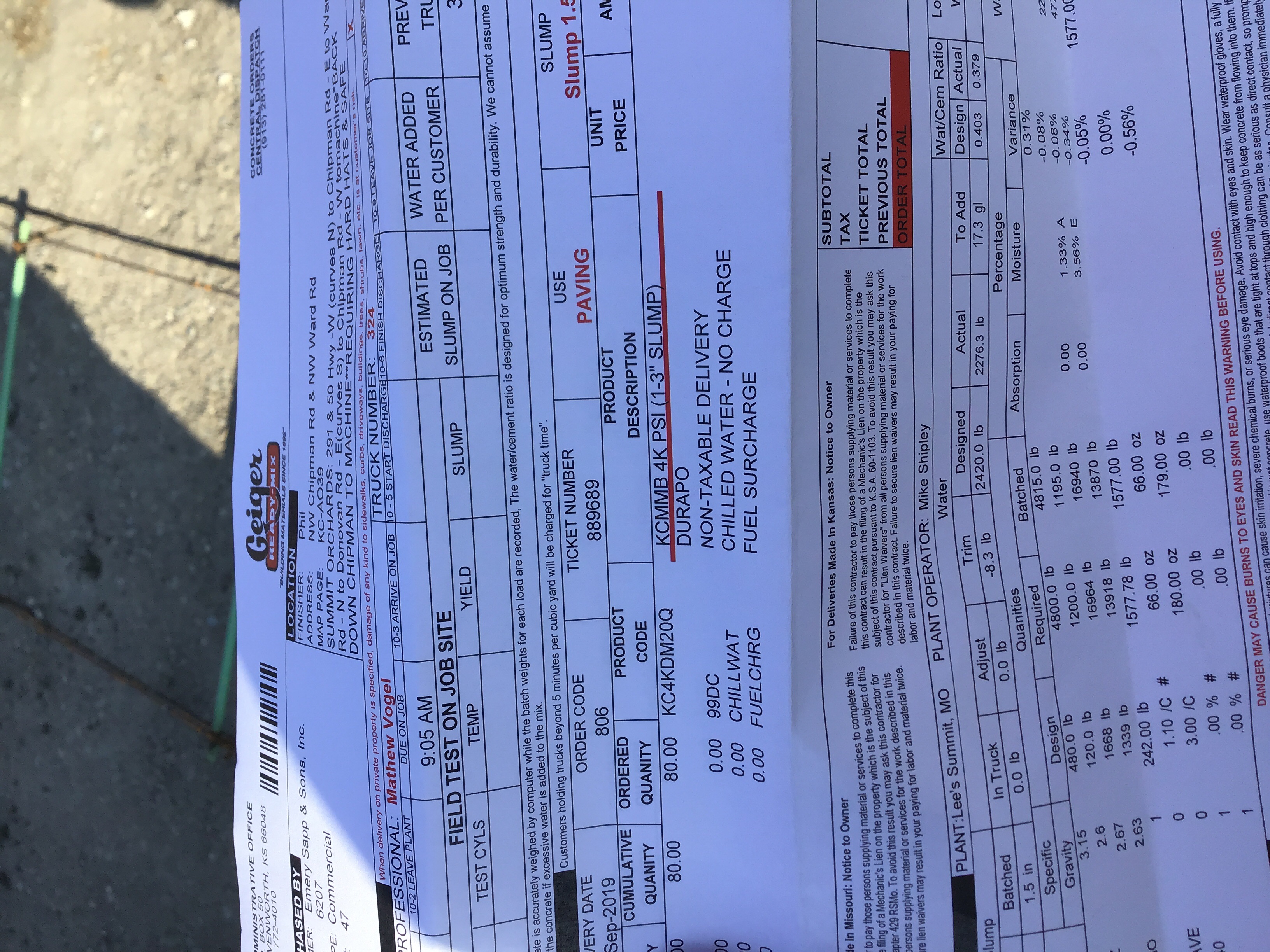

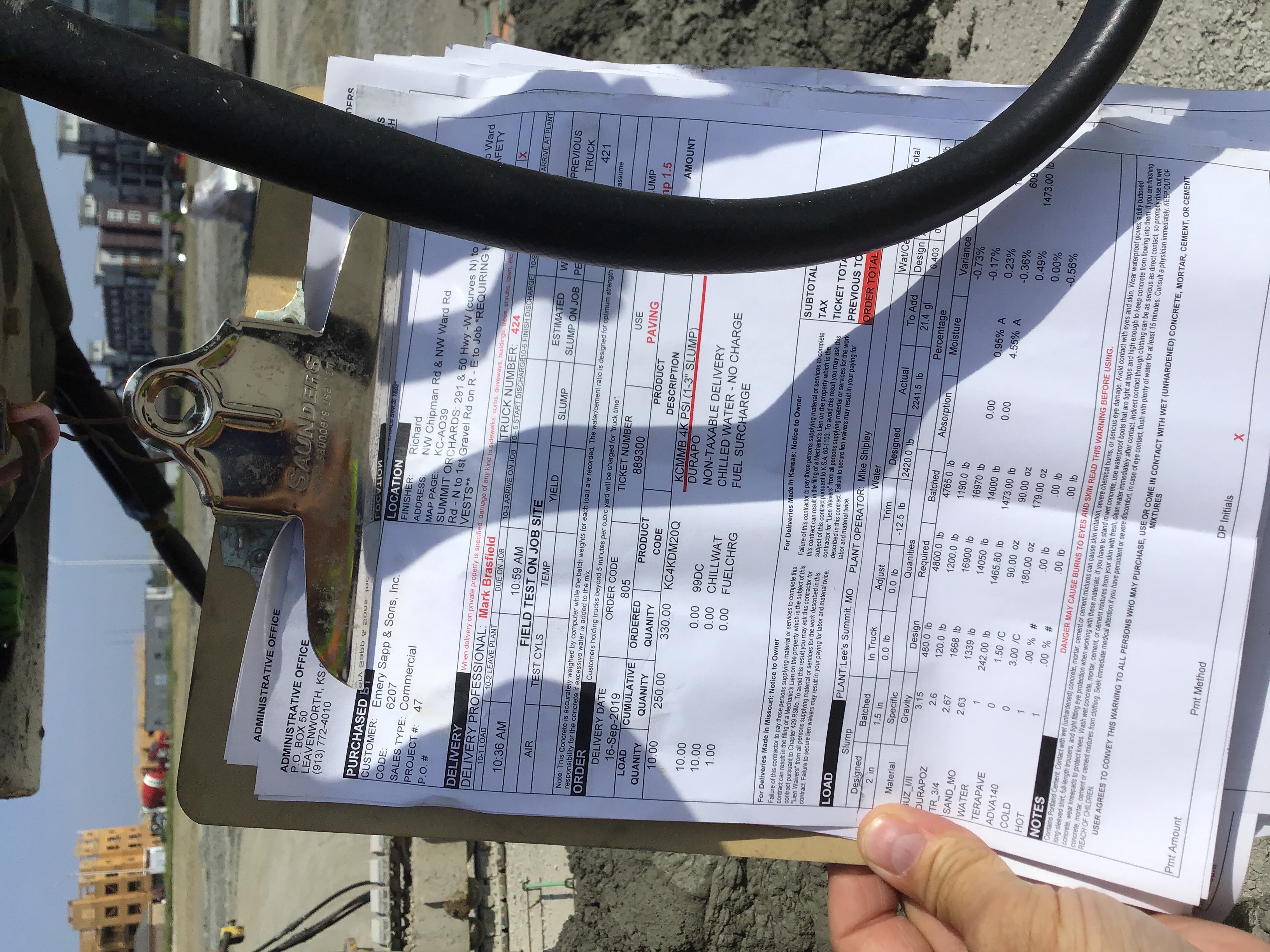

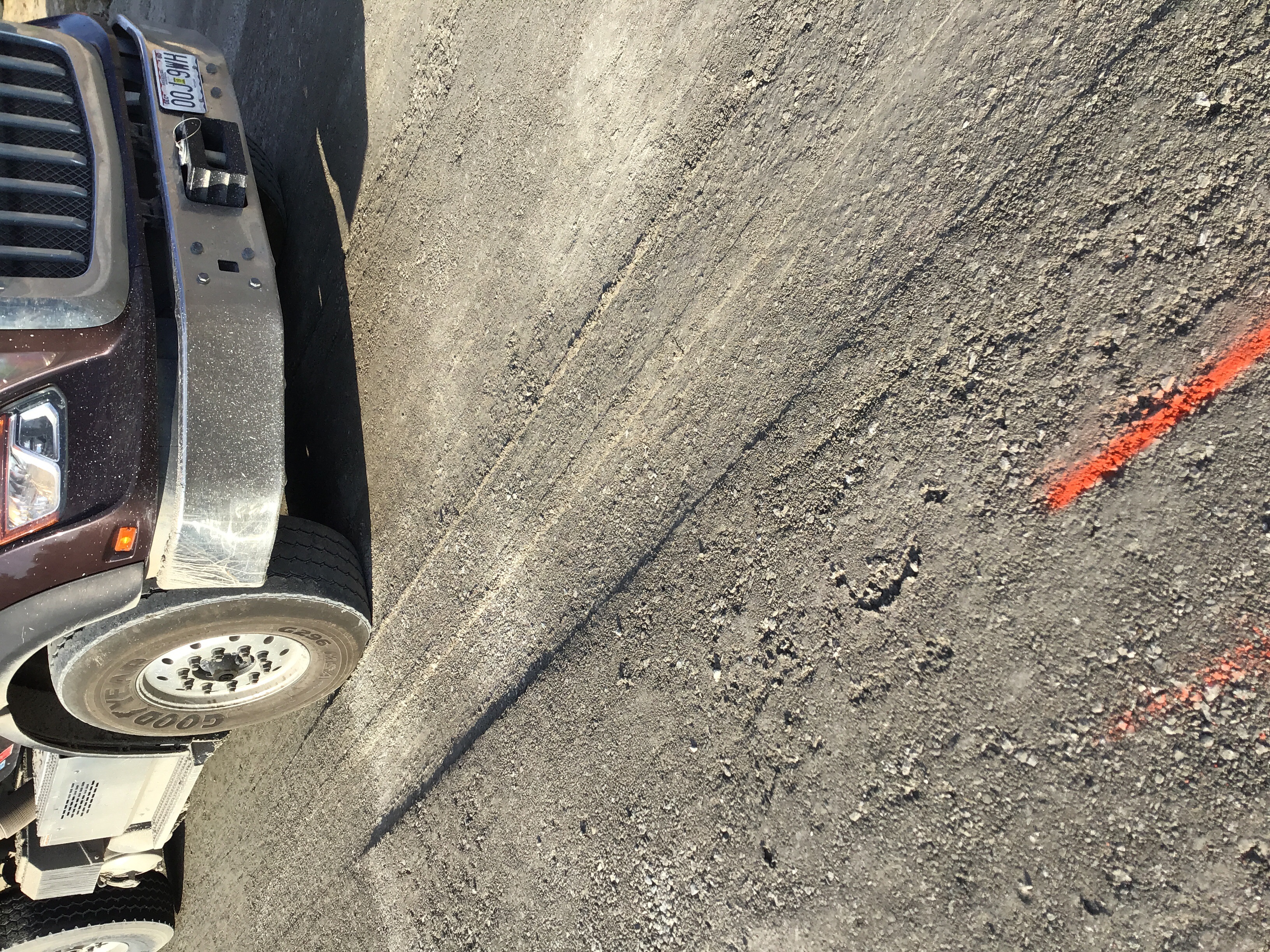

9-12-19 7:37am 7:30am proof roll. The truck for the proof roll is not on site yet. We will be proof rolling all roads and turn lanes on site. 8:11am The truck just arrived. The truck has 20 ton load. The turn lane off Ward failed with heavy pumping. The inlet on the west side failed. The the inlet on the turn lane on Chipman failed along with the entrance. Bill will be making corrections and we will proof roll again. The road running east and west passed on the north side.
Proof roll parking lot Partial 9/13/2019 09/13/2019
Misc
Informational
09/12/2019
9-12-19 7:37am 7:30am proof roll. The truck for the proof roll is not on site yet. We will be proof rolling all roads and turn lanes on site. 8:11am The truck just arrived. The truck has 20 ton load. The turn lane off Ward failed with heavy pumping. The inlet on the west side failed. The the inlet on the turn lane on Chipman failed along with the entrance. Bill will be making corrections and we will proof roll again. The road running east and west passed on the north side.
Misc
Informational
09/13/2019
9-13-19 8:15am We proof rolled the curb line on ward rd for the turn lane. The east side passed and the west side failed.
Site Visit Partial 09/13/2019
Misc
Informational
08/30/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
08/30/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
08/30/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
08/30/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
08/30/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
08/30/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
08/30/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
09/13/2019
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Proof roll parking lot Partial 9/16/2019 09/16/2019
Misc
Informational
09/13/2019
9-12-19 7:37am 7:30am proof roll. The truck for the proof roll is not on site yet. We will be proof rolling all roads and turn lanes on site. 8:11am The truck just arrived. The truck has 20 ton load. The turn lane off Ward failed with heavy pumping. The inlet on the west side failed. The the inlet on the turn lane on Chipman failed along with the entrance. Bill will be making corrections and we will proof roll again. The road running east and west passed on the north side.
Misc
Informational
09/13/2019
9-13-19 8:15am We proof rolled the curb line on ward rd for the turn lane. The east side passed and the west side failed.
Misc
Informational
09/16/2019
9-16-19 The road and turn lane have passed the proof roll with a couple small corrections. The turn lane on Ward has passed.

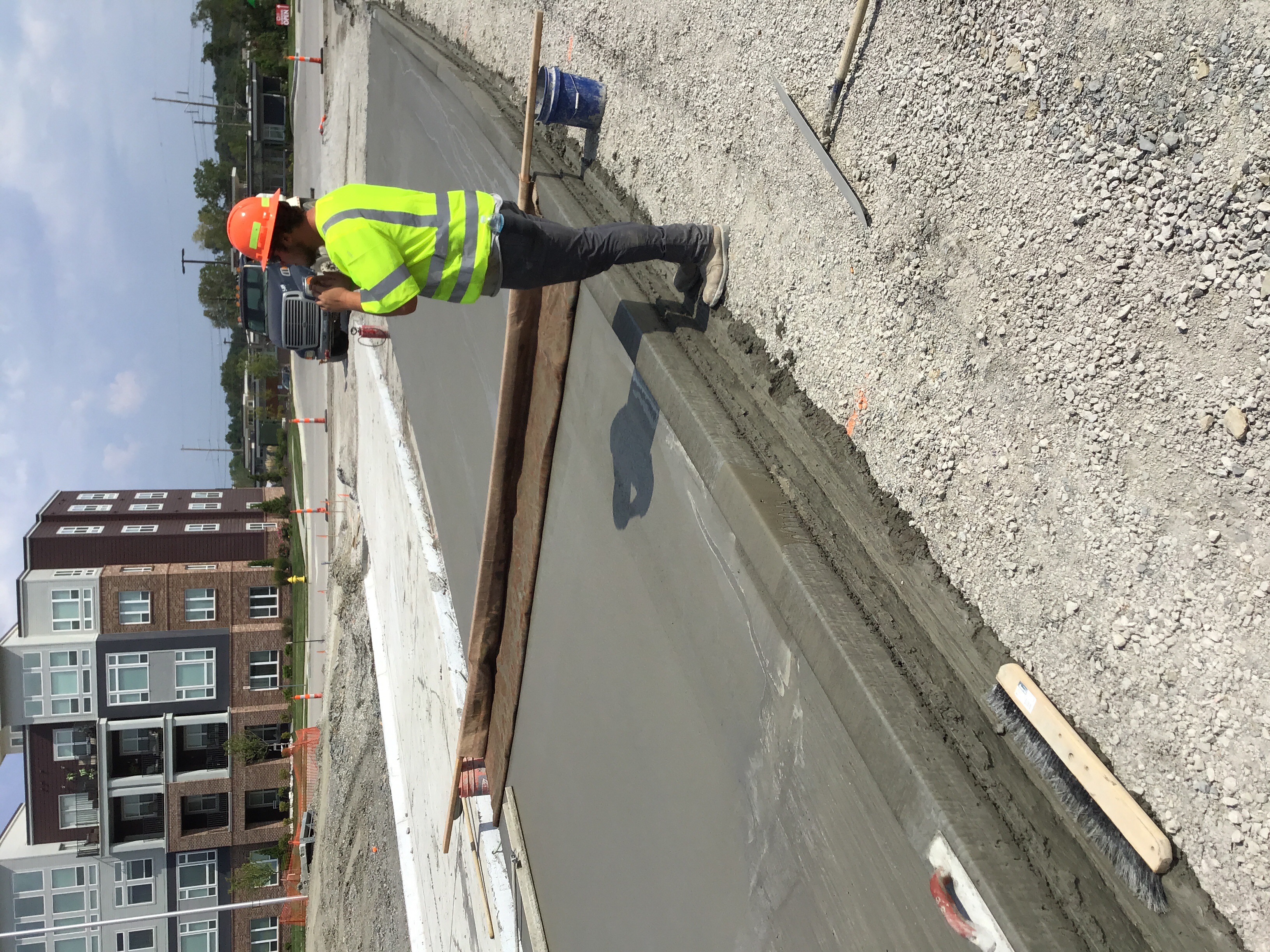

Street - Concrete Partial 9/16/2019 09/16/2019
Misc
Informational
09/16/2019

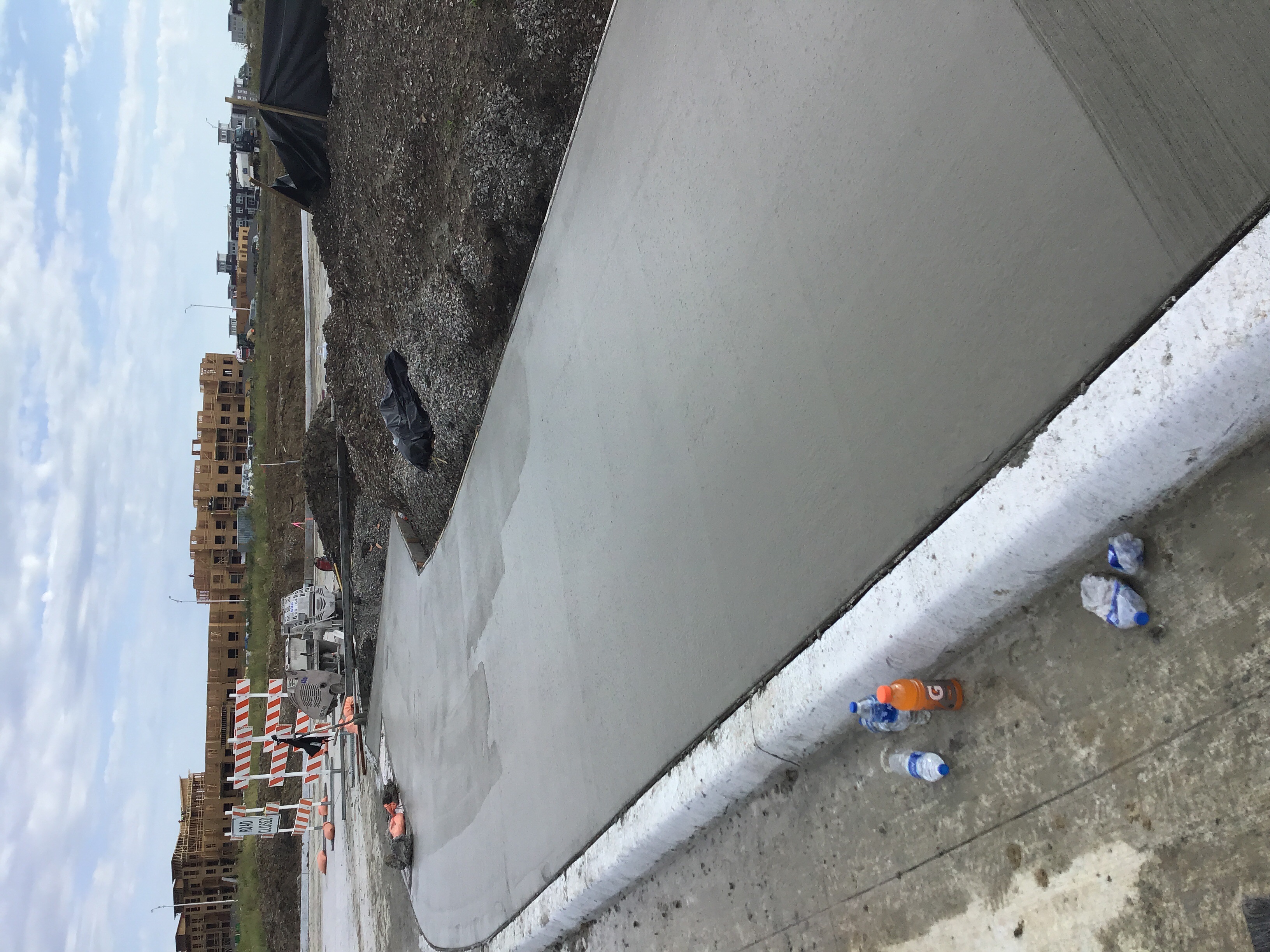

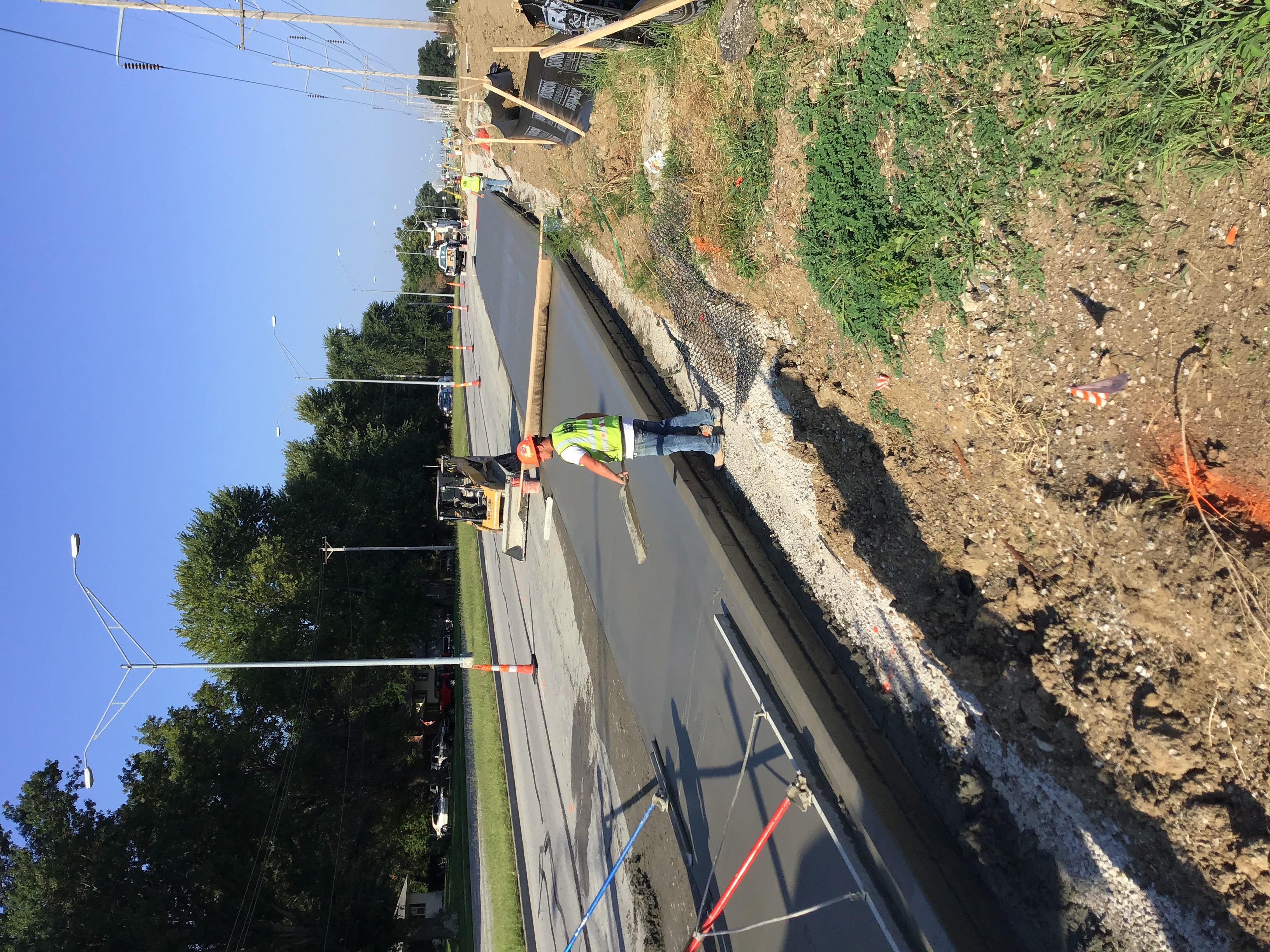

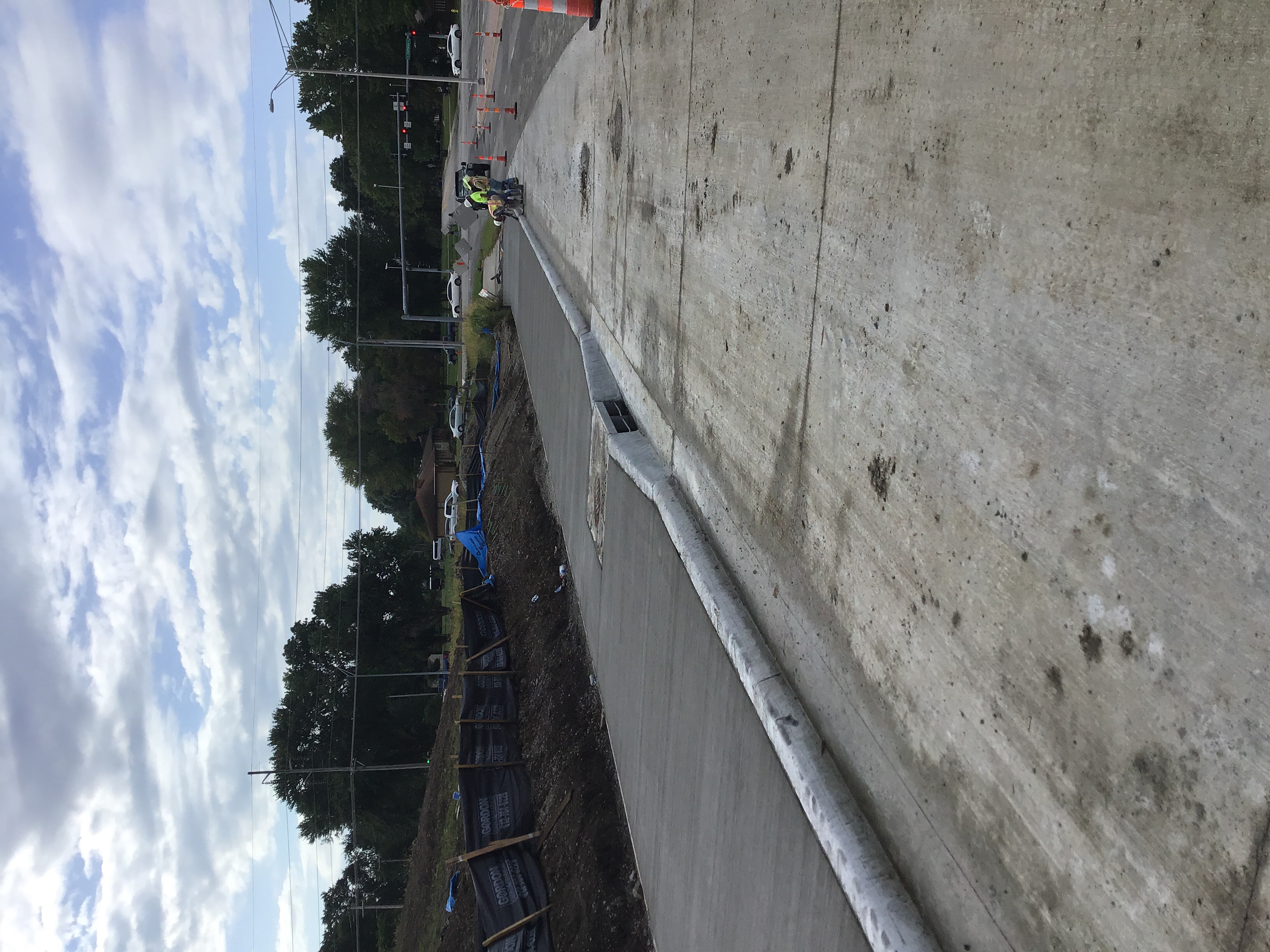

9-16-19 They are pouring the road that’s runs east and west on the site. Baskets have been placed and after some discussion they are now clipping the hold wire. 9:50am they are at approximately 400 feet. 12:48pm They are coming up to the header on the east end of the road.12:58pm The have reached the header.2:17pm They have started pouring the road that runs north and south. They have started saw cutting the east west road. 2:47pm The last truck to get them to the header just arrived.2:57pm They just pulled off the header at the south end of the road.
Site Visit Partial 09/17/2019
Misc
Informational
09/13/2019

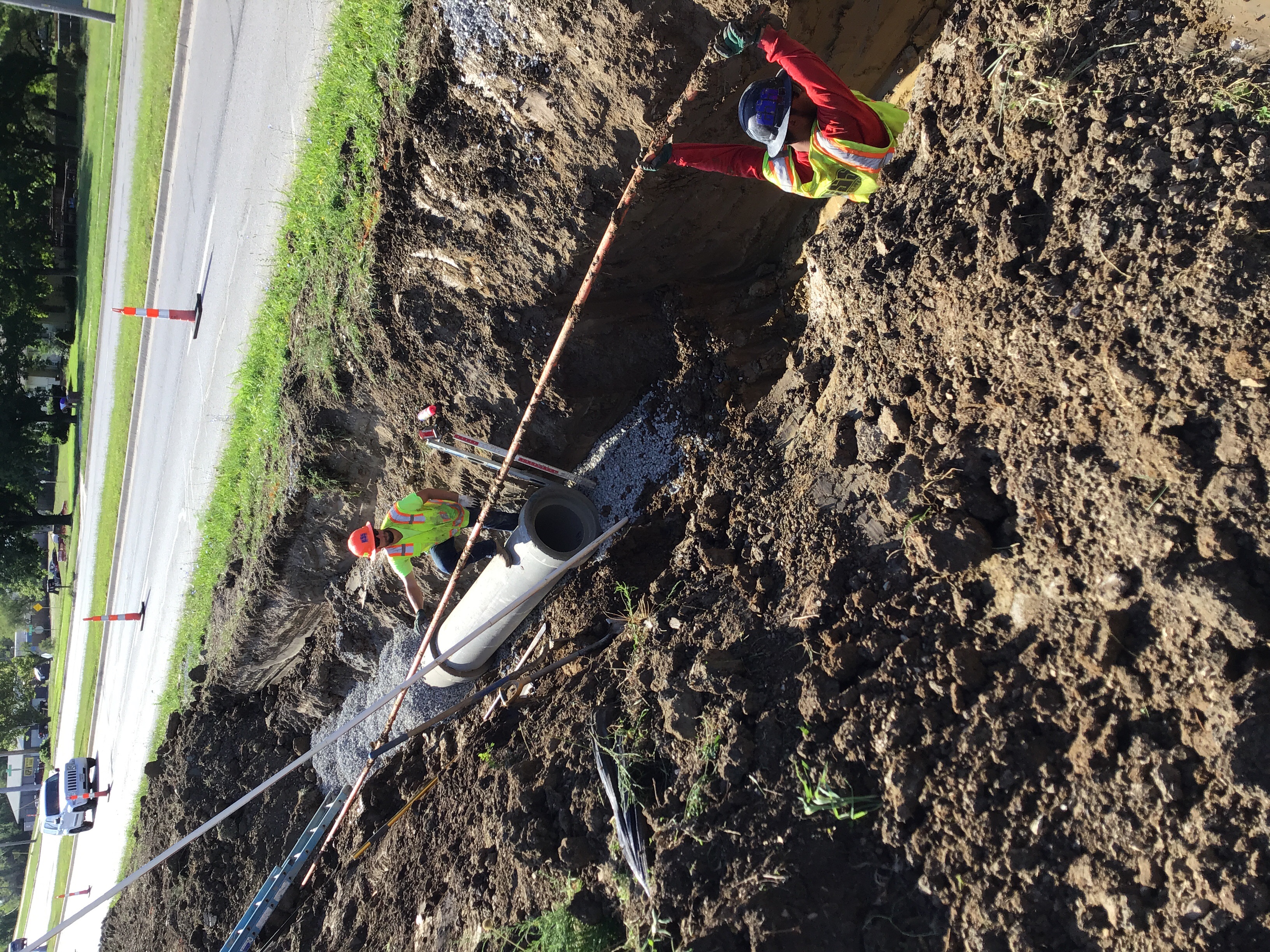

8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
09/13/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
09/13/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
09/13/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
09/13/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
09/13/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
09/13/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
09/13/2019

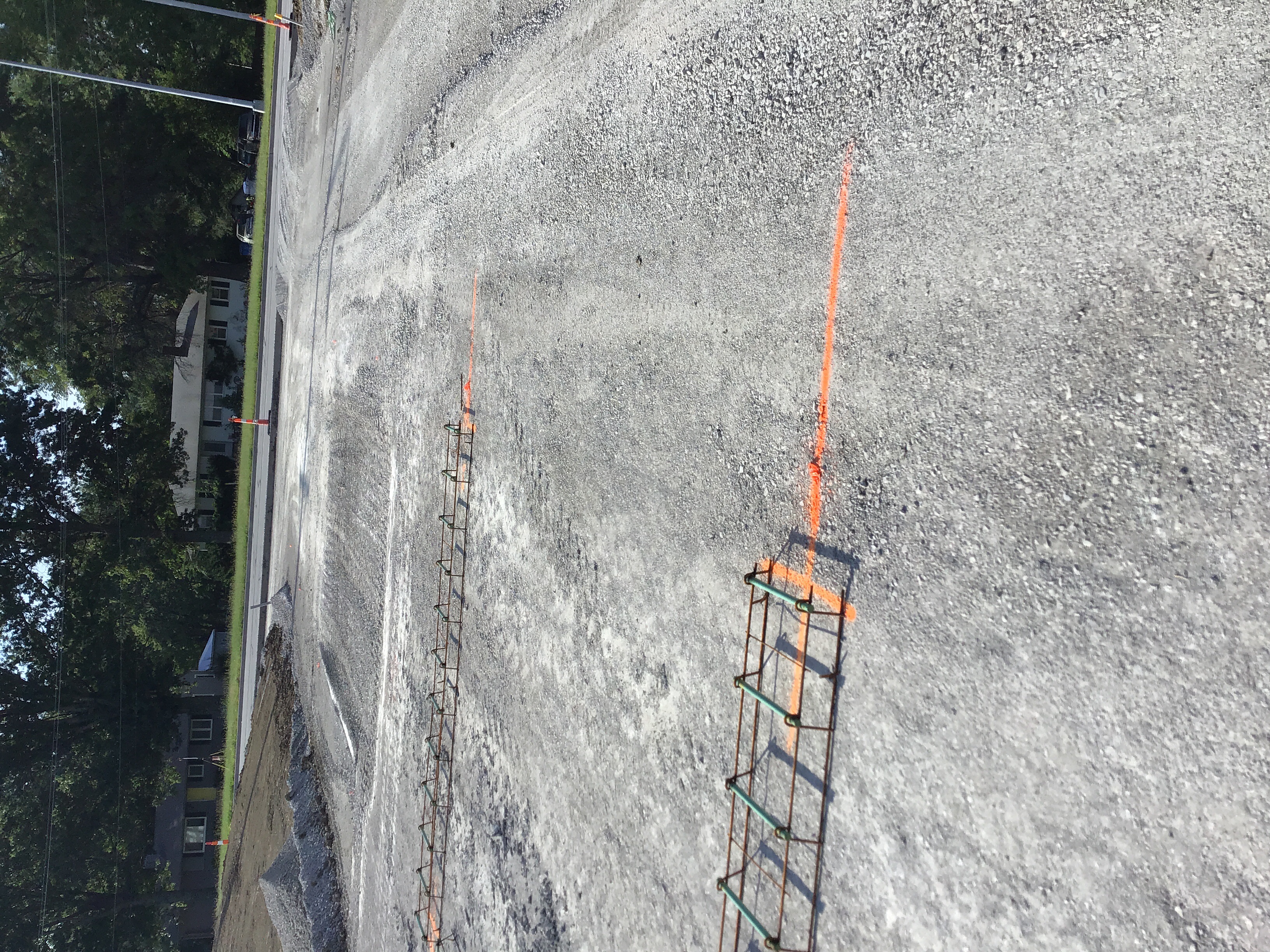

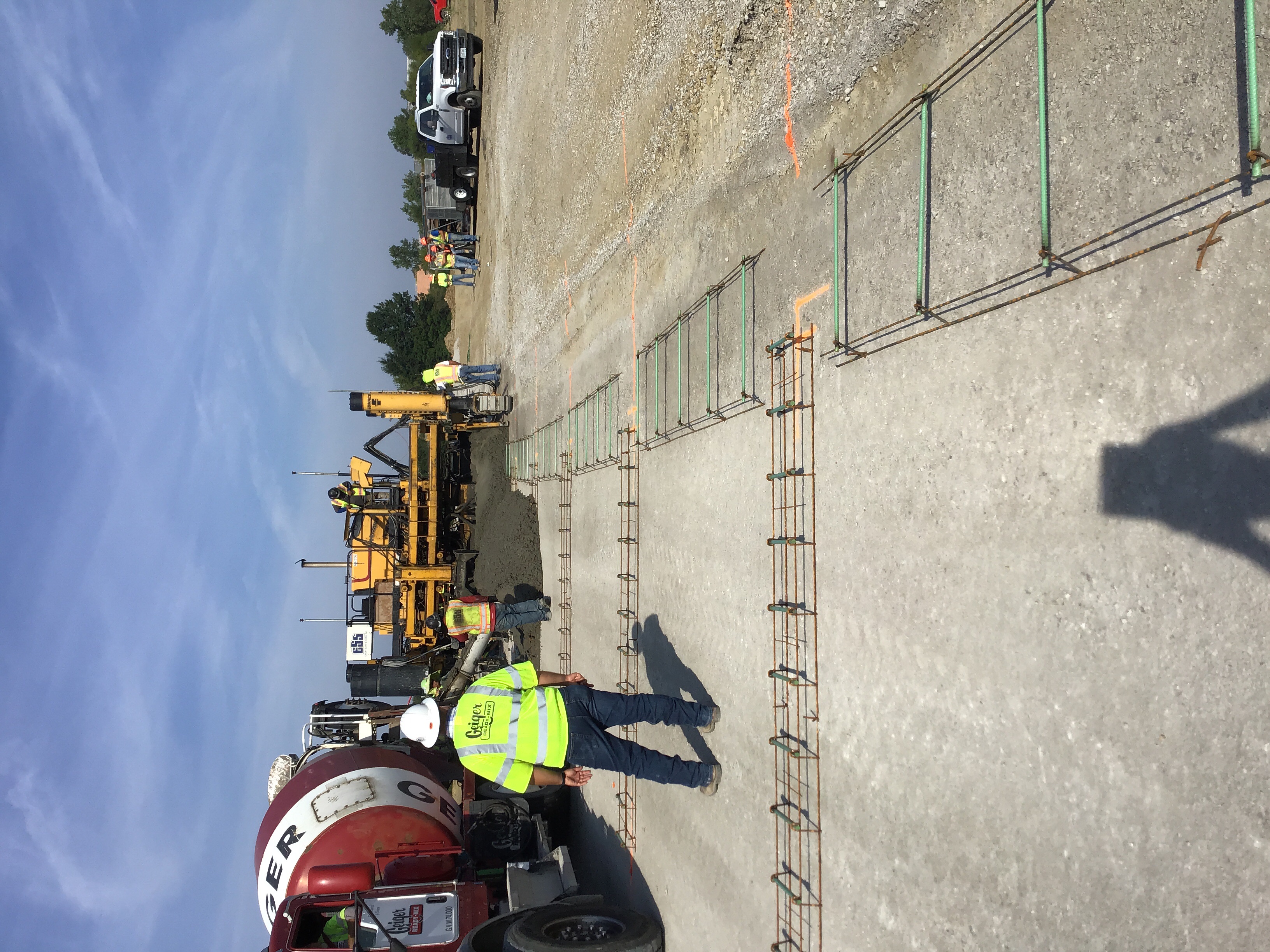

9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
09/17/2019

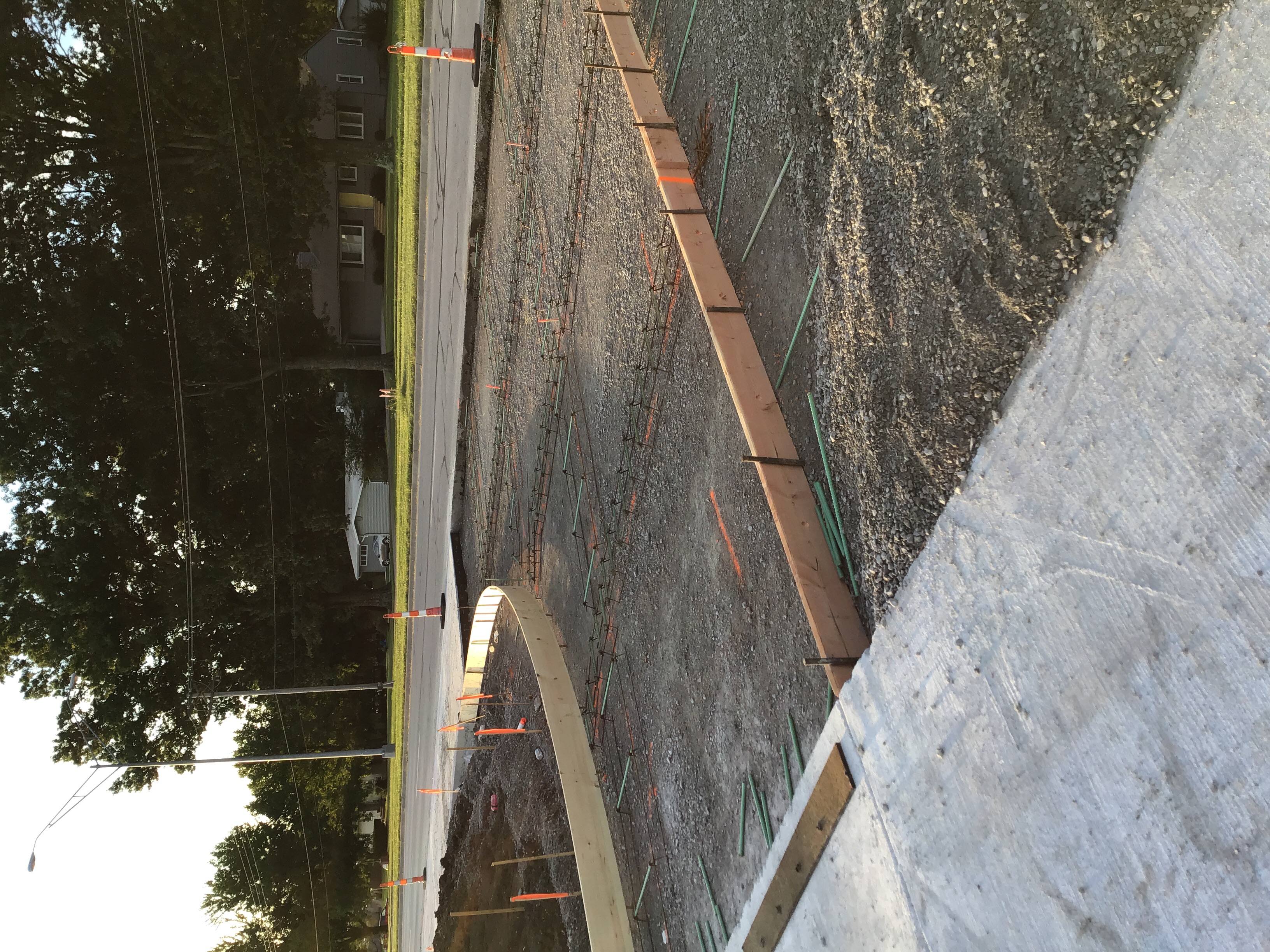

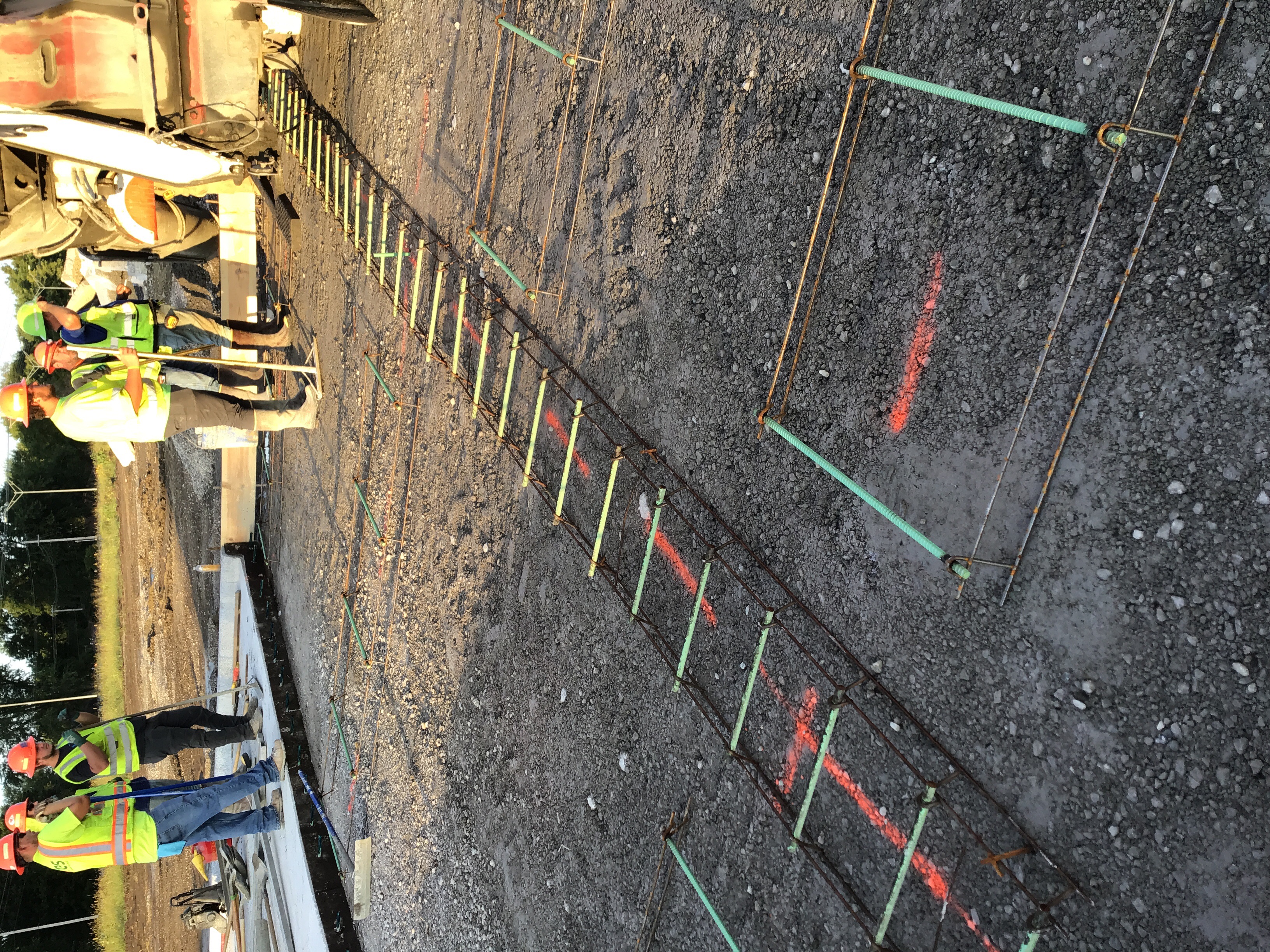

9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Proof roll parking lot Partial 9/17/2019 09/17/2019
Misc
Informational
09/16/2019
9-12-19 7:37am 7:30am proof roll. The truck for the proof roll is not on site yet. We will be proof rolling all roads and turn lanes on site. 8:11am The truck just arrived. The truck has 20 ton load. The turn lane off Ward failed with heavy pumping. The inlet on the west side failed. The the inlet on the turn lane on Chipman failed along with the entrance. Bill will be making corrections and we will proof roll again. The road running east and west passed on the north side.
Misc
Informational
09/16/2019
9-13-19 8:15am We proof rolled the curb line on ward rd for the turn lane. The east side passed and the west side failed.
Misc
Informational
09/16/2019
9-16-19 The road and turn lane have passed the proof roll with a couple small corrections. The turn lane on Ward has passed.
Misc
Informational
09/17/2019
9-17-19 3:57pm We are proof rolling the south side of the east west road and the west side of the north south road. The truck has 20.48 ton. The proof roll has passed with a couple small corrections.
Street - Concrete Partial 9/19/2019 09/19/2019
Misc
Informational
09/16/2019
9-16-19 They are pouring the road that’s runs east and west on the site. Baskets have been placed and after some discussion they are now clipping the hold wire. 9:50am they are at approximately 400 feet. 12:48pm They are coming up to the header on the east end of the road.12:58pm The have reached the header.2:17pm They have started pouring the road that runs north and south. They have started saw cutting the east west road. 2:47pm The last truck to get them to the header just arrived.2:57pm They just pulled off the header at the south end of the road.
Misc
Informational
09/19/2019

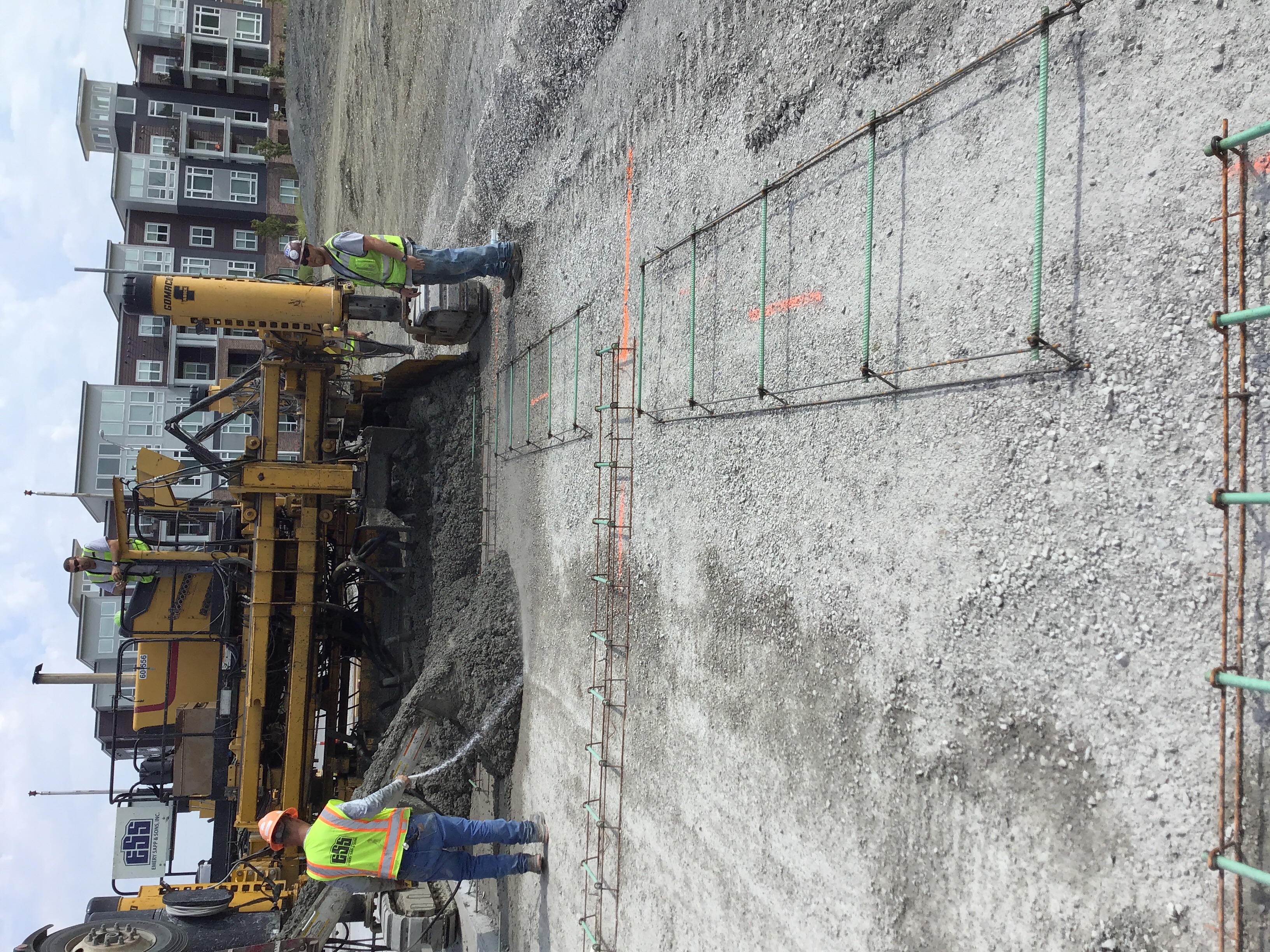

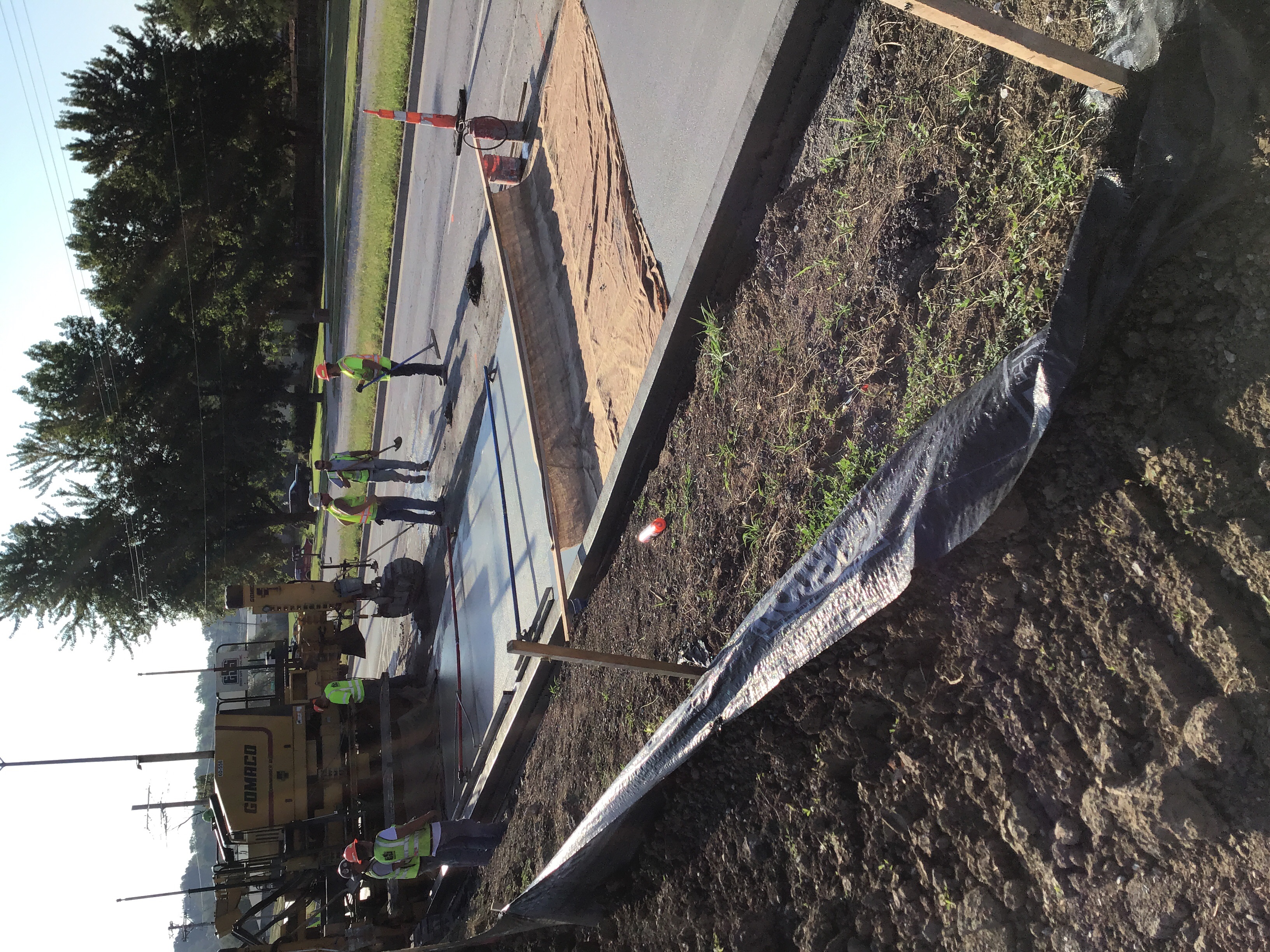

9-19-19 7am They are getting ready to pour the turn Iane on Chipman first. 7:30am The first truck is on site 9:30am They finished the turn lane on Chipman. They are starting the north south lane. 12:30pm They are finished with the north south road and are pouring the east west road. They have started at the east end pouring to the west. They are saw cutting the turn lane on Chipman. Terricon is doing the testing. 2:26pm They are saw cutting the north south road. They have approximately 500 feet poured heading west.
Street - Concrete Partial 9/20/2019 09/20/2019
Misc
Informational
09/20/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.

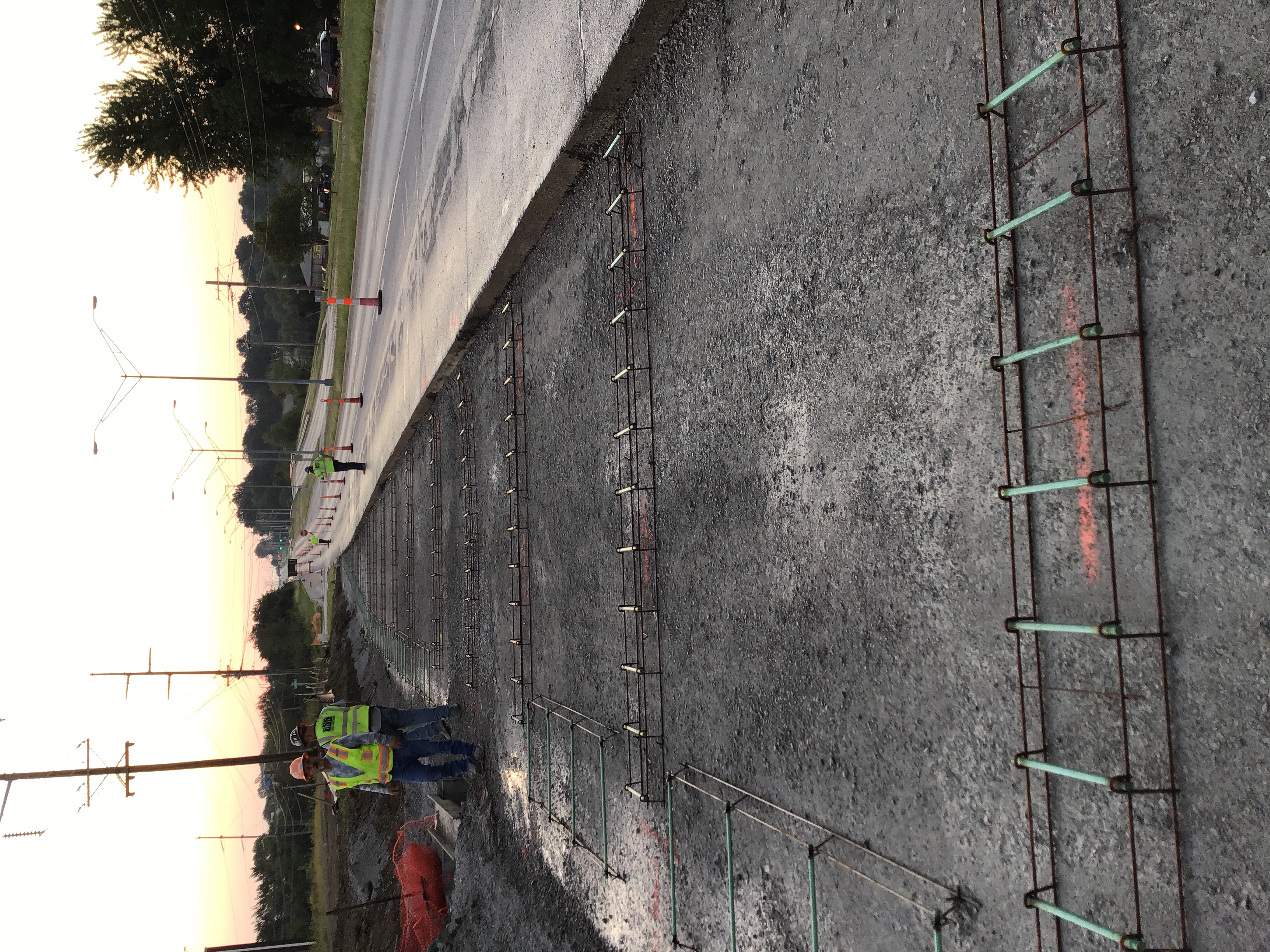

Site Visit Partial 9/23/2019 09/23/2019
Misc
Informational
09/17/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
09/17/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
09/17/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
09/17/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
09/17/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
09/17/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
09/17/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
09/17/2019
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
09/17/2019
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
09/18/2019
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
09/23/2019

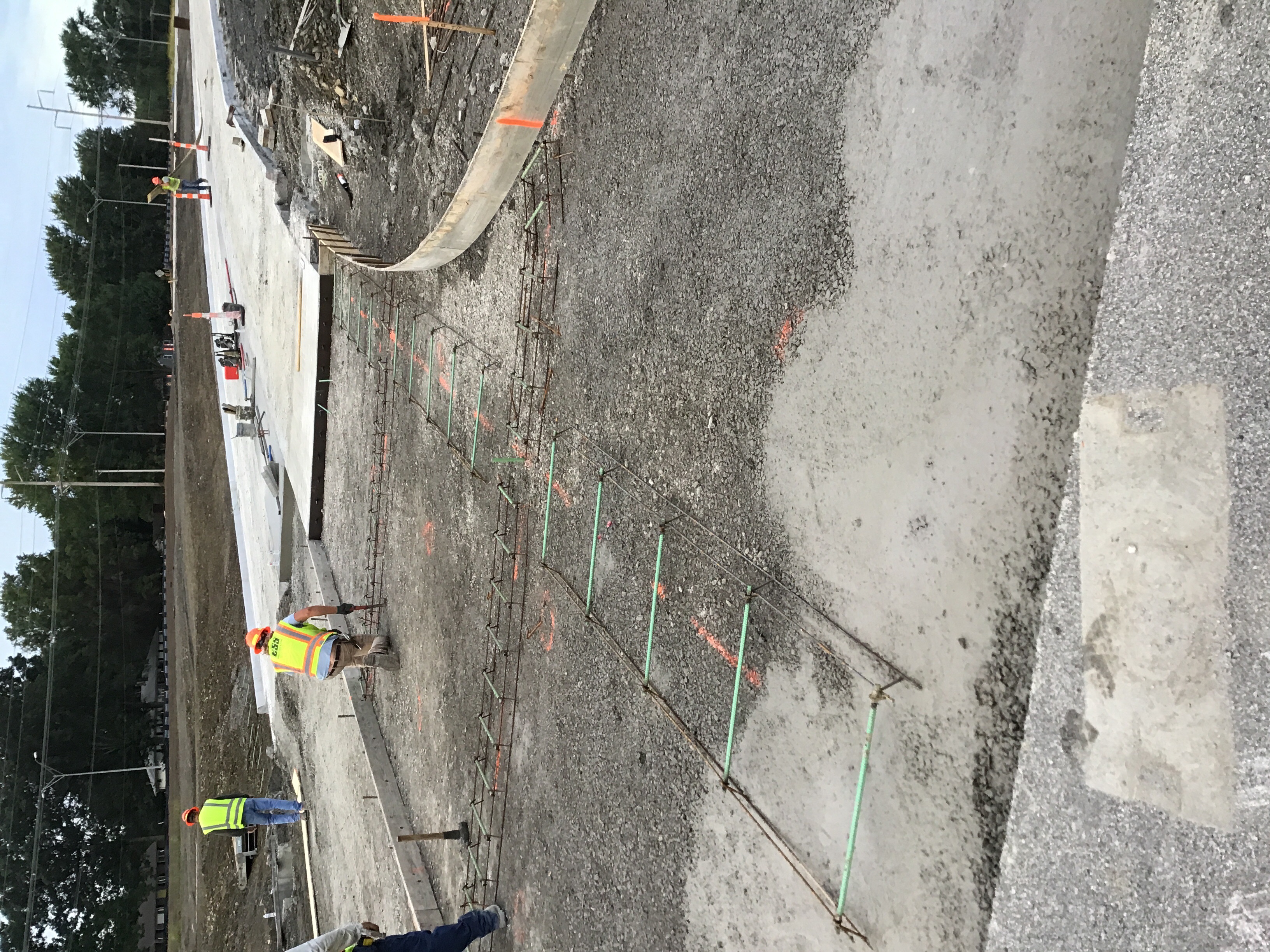

9-23-19 They are working on setting up hand poures at the west end of the site.
Street - Concrete Partial 9/24/2019 09/24/2019
Misc
Informational
09/20/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/24/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Street - Concrete Partial 9/25/2019 09/25/2019
Misc
Informational
09/24/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/24/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/25/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Street - Concrete Partial 9/26/2019 09/26/2019
Misc
Informational
09/25/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
09/25/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/25/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/26/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Street - Concrete Partial 09/27/2019
Misc
Informational
09/26/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
09/26/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/26/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/26/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
09/27/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Street - Concrete Partial 09/30/2019
Misc
Informational
09/27/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
09/27/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/27/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/27/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
09/27/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Street - Concrete Partial 9/30/2019 09/30/2019
Misc
Informational
09/30/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
09/30/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/30/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/30/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
09/30/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Misc
Informational
09/30/2019
9-30-19 9:04am The approache at Chipman needs some corrections then can be poured in the afternoon. 1:18pm They have poured the approache coming off Chipman and are working on inlets on the east west road.
Proof roll parking lot Passed 10/1/2019 10/01/2019
Misc
Informational
09/17/2019
9-12-19 7:37am 7:30am proof roll. The truck for the proof roll is not on site yet. We will be proof rolling all roads and turn lanes on site. 8:11am The truck just arrived. The truck has 20 ton load. The turn lane off Ward failed with heavy pumping. The inlet on the west side failed. The the inlet on the turn lane on Chipman failed along with the entrance. Bill will be making corrections and we will proof roll again. The road running east and west passed on the north side.
Misc
Informational
09/17/2019
9-13-19 8:15am We proof rolled the curb line on ward rd for the turn lane. The east side passed and the west side failed.
Misc
Informational
09/17/2019
9-16-19 The road and turn lane have passed the proof roll with a couple small corrections. The turn lane on Ward has passed.
Misc
Informational
09/17/2019
9-17-19 3:57pm We are proof rolling the south side of the east west road and the west side of the north south road. The truck has 20.48 ton. The proof roll has passed with a couple small corrections.
Misc
Informational
10/01/2019
We proof rolled the turn lane on Ward. It passed and they will be pouring it at approximately 8:30am.
Street - Concrete Partial 10/1/2019 10/01/2019
Misc
Informational
09/30/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
09/30/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
09/30/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
09/30/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
09/30/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Misc
Informational
09/30/2019
9-30-19 9:04am The approache at Chipman needs some corrections then can be poured in the afternoon. 1:18pm They have poured the approache coming off Chipman and are working on inlets on the east west road.
Misc
Informational
10/01/2019
10-1-19 They have poured the turn lane on Ward and it is cured. They are working on setting up inlets and pouring them. A second crew are setting up the ten foot wide sidewalk along Ward Rd. They will be pouring it on 10-2-19.
Sidewalk Inspection Partial 10/02/2019
Misc
Informational
10/02/2019
10-2-19 8:15am On 10-1-19 The forms were set and I spoke with the Forman about staying ADA compliant and to use white cure and cover evenly. 10-2-19 They are pouring 10’ wide sidewalk along Ward Rd. Rain is forecasted later today. 10:01am They have finished pouring the sidewalk and will just need to cure. I have collected tickets. They used KCMMB 4K MIX.
Street - Concrete Partial 10/2/2019 10/02/2019
Misc
Informational
10/01/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
10/01/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
10/01/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
10/01/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
10/01/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Misc
Informational
10/01/2019
9-30-19 9:04am The approache at Chipman needs some corrections then can be poured in the afternoon. 1:18pm They have poured the approache coming off Chipman and are working on inlets on the east west road.
Misc
Informational
10/01/2019
10-1-19 They have poured the turn lane on Ward and it is cured. They are working on setting up inlets and pouring them. A second crew are setting up the ten foot wide sidewalk along Ward Rd. They will be pouring it on 10-2-19.
Misc
Informational
10/02/2019

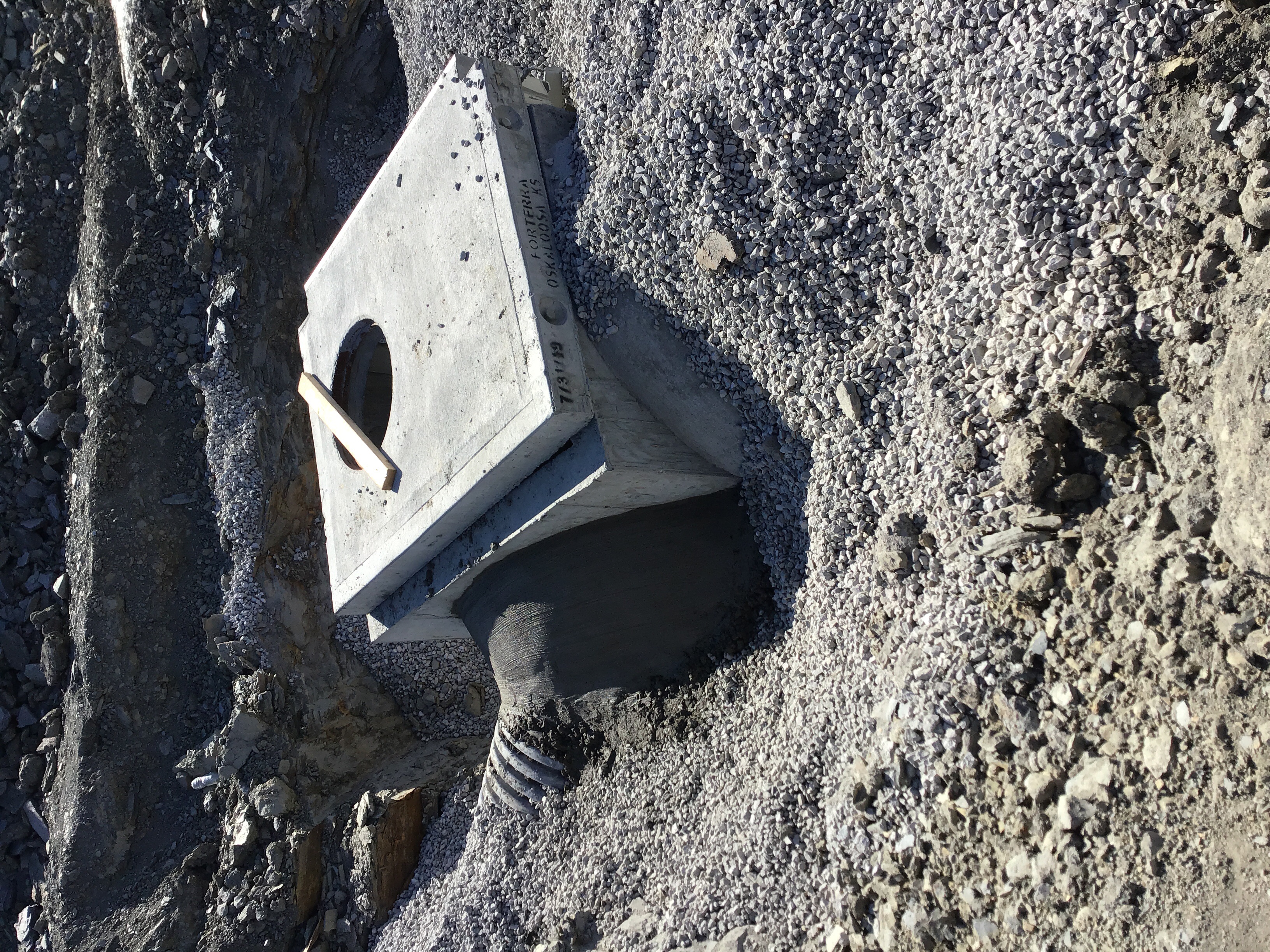

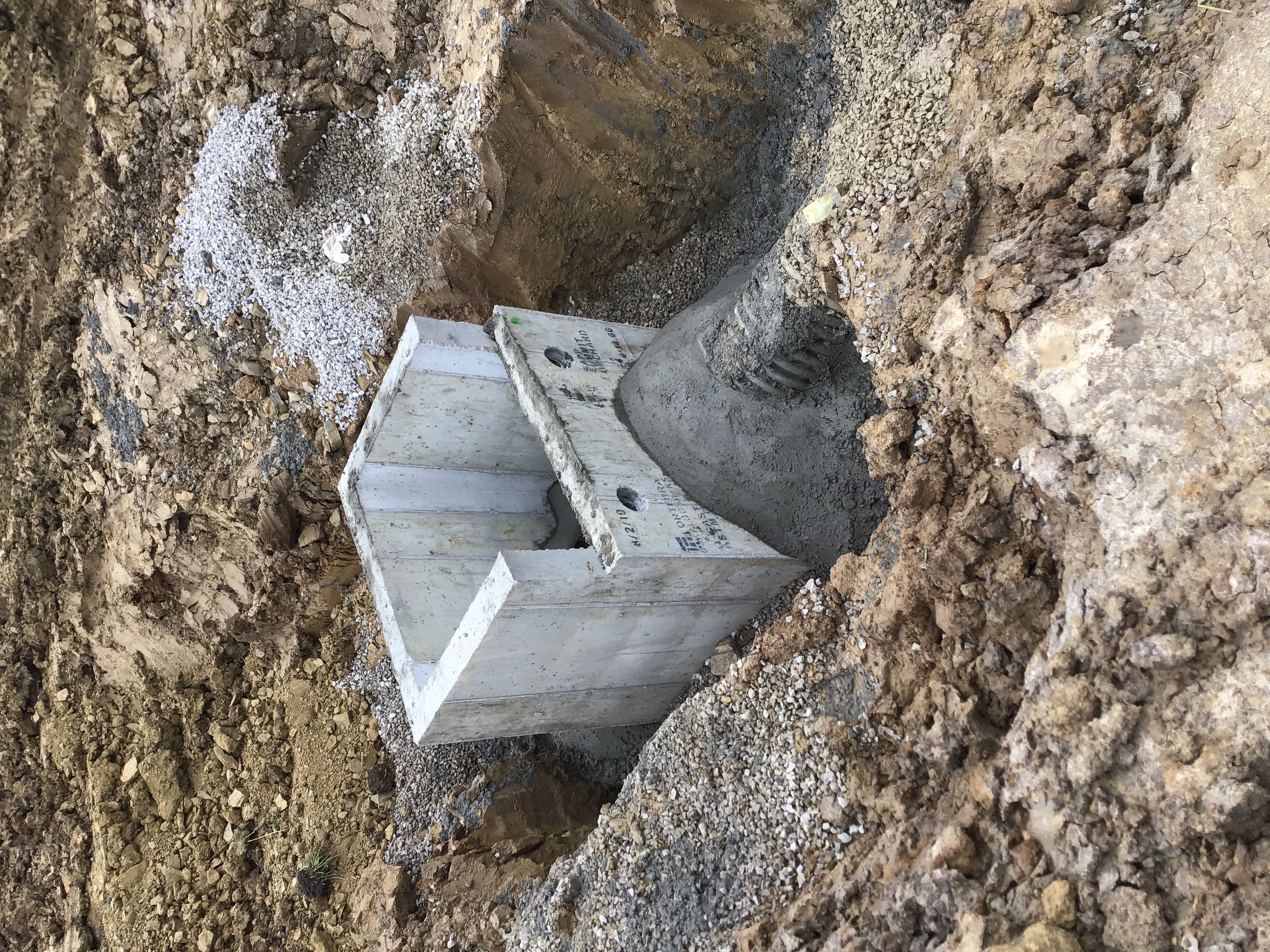

10-2-19 3:17pm They have poured storm inlets and are setting up for sidewalk.
Street - Concrete Partial 10/3/2019 10/03/2019
Misc
Informational
10/02/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
10/02/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
10/02/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
10/02/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
10/02/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Misc
Informational
10/02/2019
9-30-19 9:04am The approache at Chipman needs some corrections then can be poured in the afternoon. 1:18pm They have poured the approache coming off Chipman and are working on inlets on the east west road.
Misc
Informational
10/02/2019
10-1-19 They have poured the turn lane on Ward and it is cured. They are working on setting up inlets and pouring them. A second crew are setting up the ten foot wide sidewalk along Ward Rd. They will be pouring it on 10-2-19.
Misc
Informational
10/02/2019
10-2-19 3:17pm They have poured storm inlets and are setting up for sidewalk.
Misc
Informational
10/03/2019
10-3-19 They are pouring the curb in the turning lane on Ward Rd.
Sidewalk Inspection Partial 10/3/2019 10/03/2019
Misc
Informational
10/03/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Street - Concrete Partial 10/4/2019 10/04/2019
Misc
Informational
09/16/2019
9-16-19 They are pouring the road that’s runs east and west on the site. Baskets have been placed and after some discussion they are now clipping the hold wire. 9:50am they are at approximately 400 feet. 12:48pm They are coming up to the header on the east end of the road.12:58pm The have reached the header.2:17pm They have started pouring the road that runs north and south. They have started saw cutting the east west road. 2:47pm The last truck to get them to the header just arrived.2:57pm They just pulled off the header at the south end of the road.
Misc
Informational
10/04/2019
10-4-19 They are pouring the red concrete between the curb on Ward turning lane.
Sidewalk Inspection Partial 10/4/2019 10/04/2019
Misc
Informational
10/03/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/04/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Sidewalk Inspection Partial 10/8/2019 10/07/2019
Misc
Informational
10/04/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/04/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/07/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Site Visit Partial 10/08/2019
Misc
Informational
09/23/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
09/23/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
09/23/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
09/23/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
09/23/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
09/23/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
09/23/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
09/23/2019
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
09/23/2019
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
09/23/2019
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
09/23/2019
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
10/08/2019
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Sidewalk Inspection Partial 10/8/2019 10/08/2019
Misc
Informational
10/07/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/07/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/07/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/08/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Site Visit Partial 10/21/2019 10/11/2019
Misc
Informational
10/08/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
10/08/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
10/08/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
10/08/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
10/08/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
10/08/2019
8-29-19 There was a operator on site working on grade.
Misc
Informational
10/08/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
10/08/2019
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
10/08/2019
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
10/08/2019
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
10/08/2019
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
10/08/2019
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Sidewalk Inspection Partial 10/16/2019 10/17/2019
Misc
Informational
10/15/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/15/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/15/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/15/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/15/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Misc
Informational
10/17/2019
10-17-19 9:01am The storm box at Ward and Chipman will be in the shared use path and it is not ADA compliant. We are working on a solution. The signal box will be lowered to meet ADA spec as well.
Pavement-Curb Construction Passed 10/14/2019 10/18/2019
Misc
Informational
10/14/2019
10-14-19 7:55am They are getting ready to pour the curb on the turn lane on Ward rd. with the paver. Terraacon is on site for testing. They have poured the curb and used white cure.
Sidewalk Inspection Passed 10/10/2019 10/18/2019
Misc
Informational
10/08/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/08/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/08/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/08/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/15/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Curb - Proof Roll Passed 10/18/2019
Pavement-Proof Roll Passed 10/18/2019
Street - Surface Course Passed 10/18/2019
Curb - Compression Strength Passed 10/18/2019
Storm - Material Verification Passed 8/5/2019 10/18/2019
Storm - Inlets Clean Passed 10/18/2019
Storm - Outlet Structure Passed 10/18/2019
Storm - Material Verification Passed 10/18/2019
Storm - Pipe Passed 10/18/2019
Misc
Informational
08/15/2019

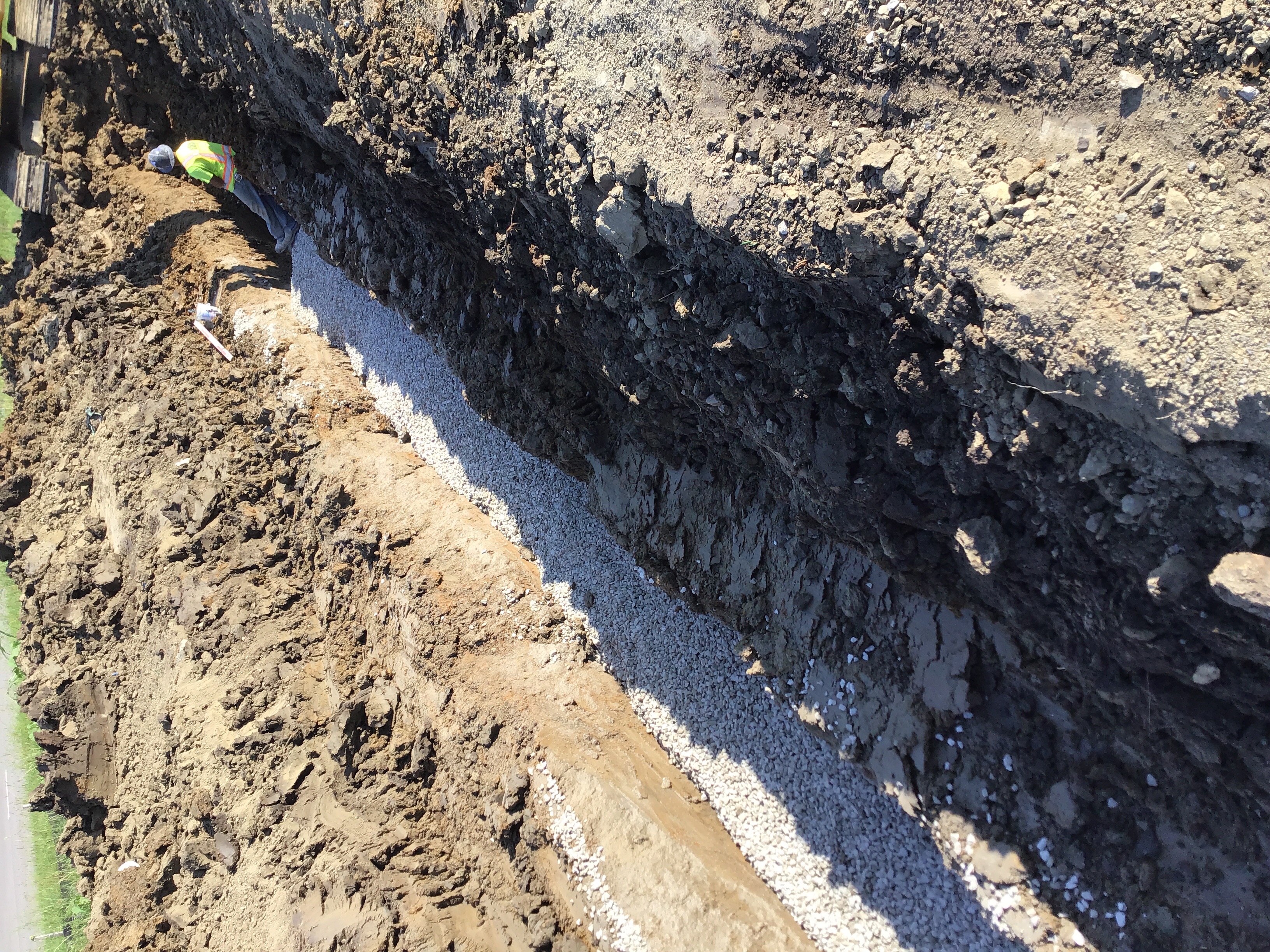

8-13-19 11:27am They have approximately 120 feet of storm installed working to A-3.
Misc
Informational
08/15/2019
8-12-19 They are cutting into the existing box to run storm pipe from A-1 into it. They got 200 foot of storm pipe installed Friday. They are backfilling with watered down shell and will be getting compaction test from Terricon. I told them that the shell needs to be crushed down a little more than what they have at 200 feet from the box. 12:01pm They are getting ready to place A-2 box. 1:56pm A-2 box is placed and they are digging across the road. C-1 is placed and pipe ran. They have two sticks of pipe coming out of A-2 heading for A-3 box. The collars have been poured on A-1 A-2 and C-1.
Misc
Informational
08/15/2019

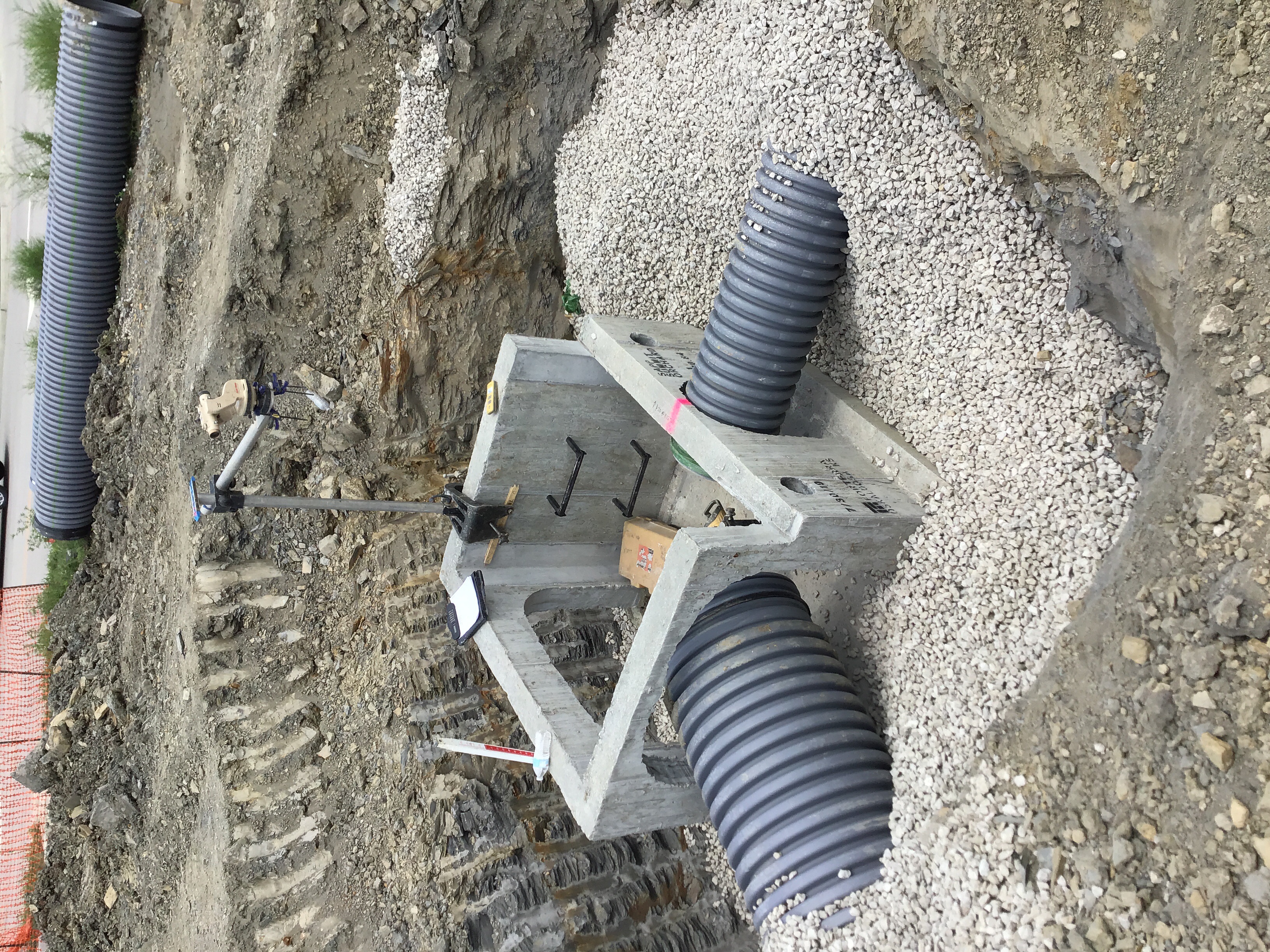

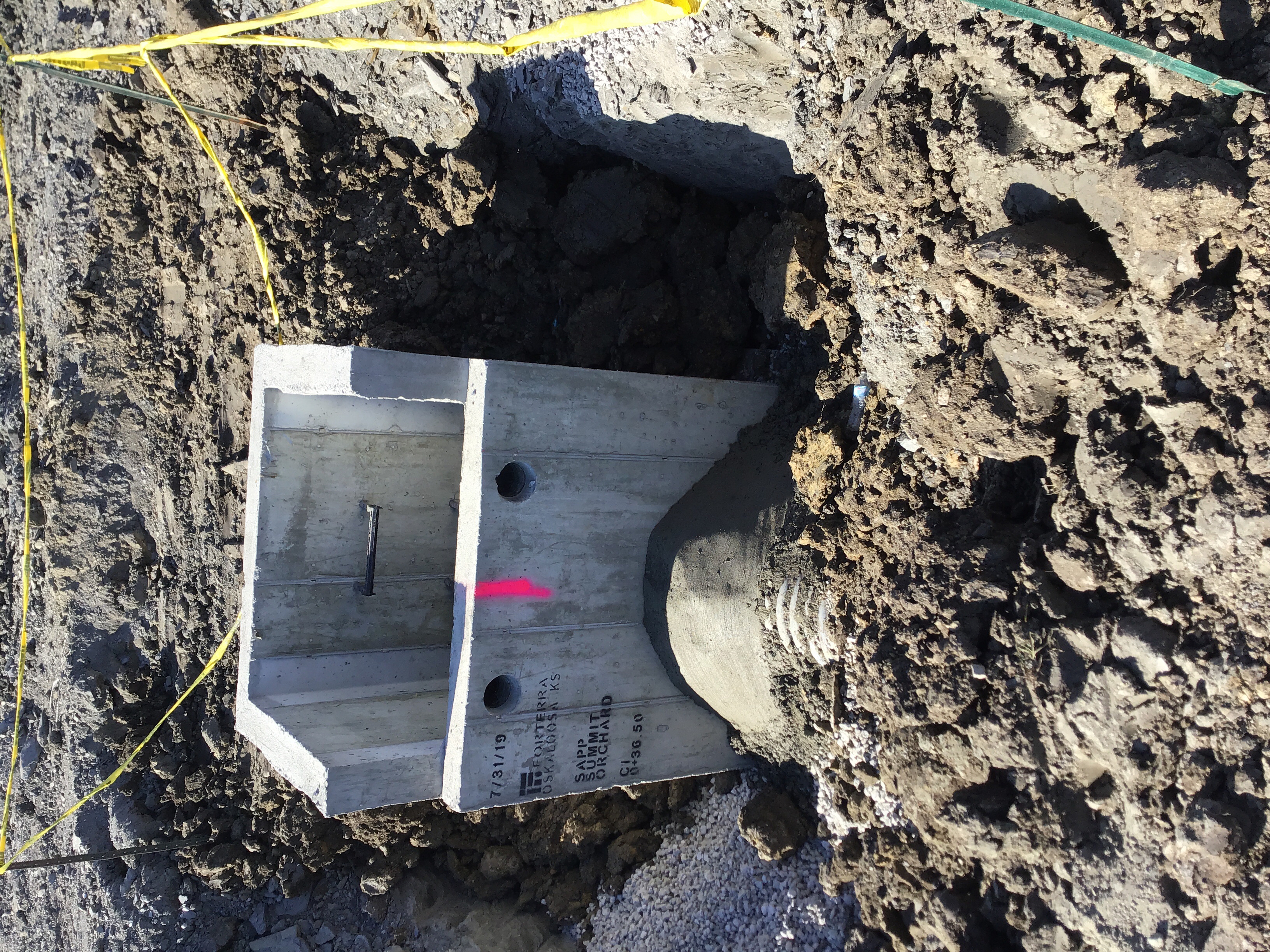

8-9-19 9:05am They have set box A-1 and are now setting D-2. 1:10pm 120 feet of storm pipe has been installed. They are digging through shell.
Misc
Informational
08/15/2019
8-8-19 E-4 is set and pipe is ran. They will be pouring collars at 10am. They are working on installing new curb inlet along Ward. The collars and inverts are poured for E-1 through E-4. The curb inlet has been installed.
Misc
Informational
08/15/2019

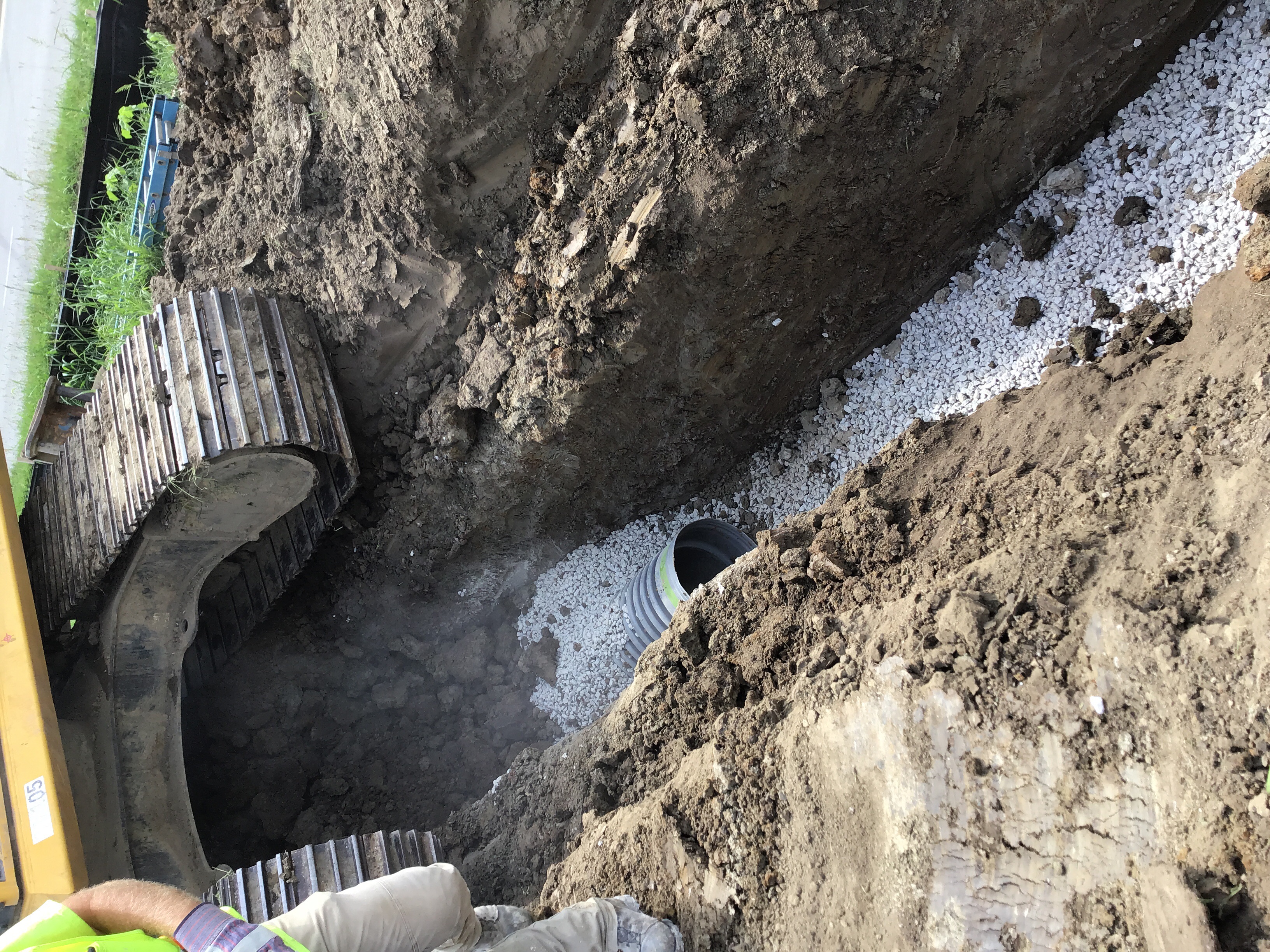

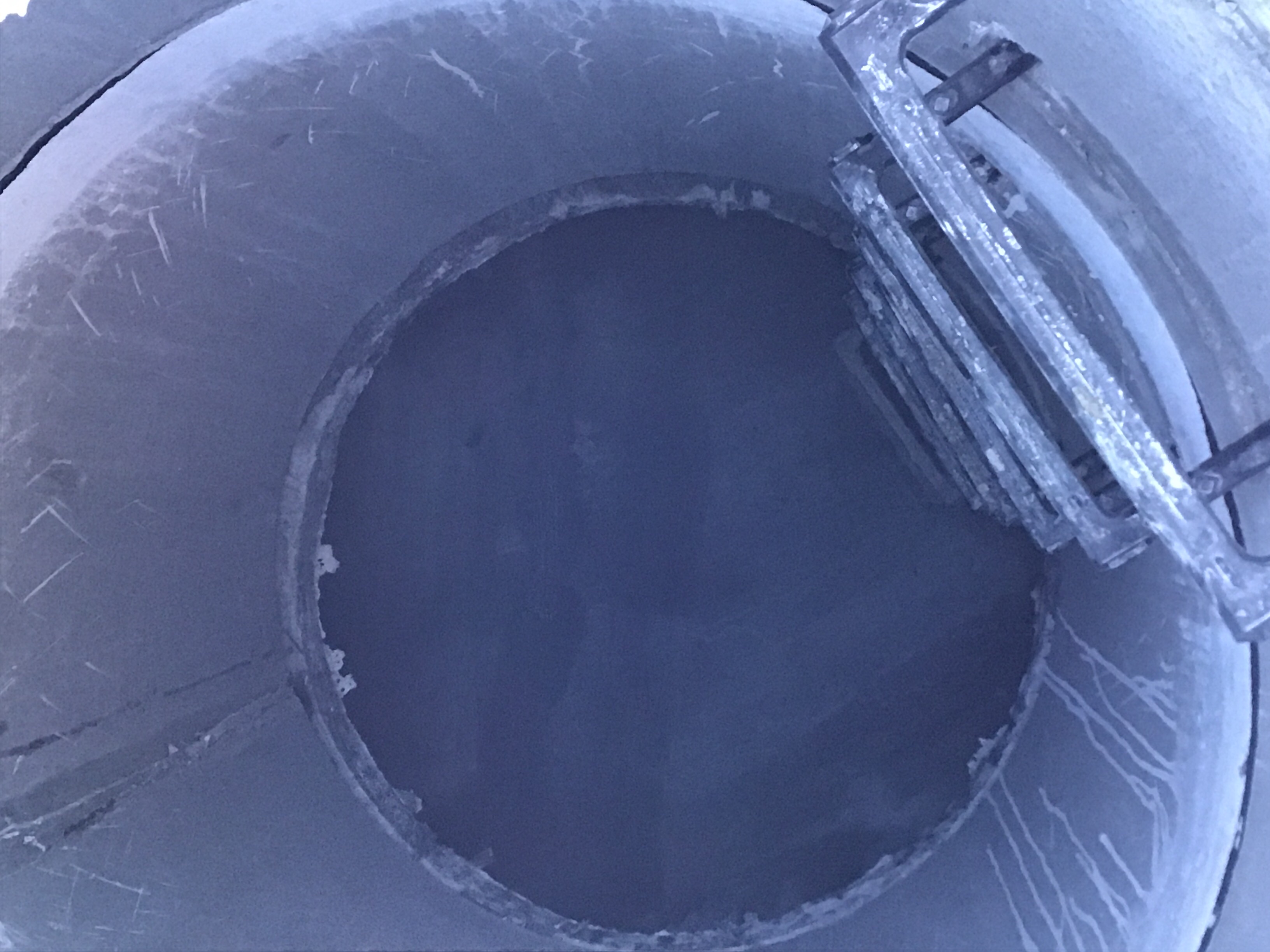

7-6-19 9:15am they have installed 3 sticks of storm heading to box E-2. 11:02am they are getting ready to place E-2 box. 3:14pm They have placed E-2 and are installing pipe to E-3
Misc
Informational
08/15/2019
8-5-19 They have set E-1 box and are placing pipe up to it. They will be pouring collars at approximately 4:30pm.
Misc
Informational
08/15/2019

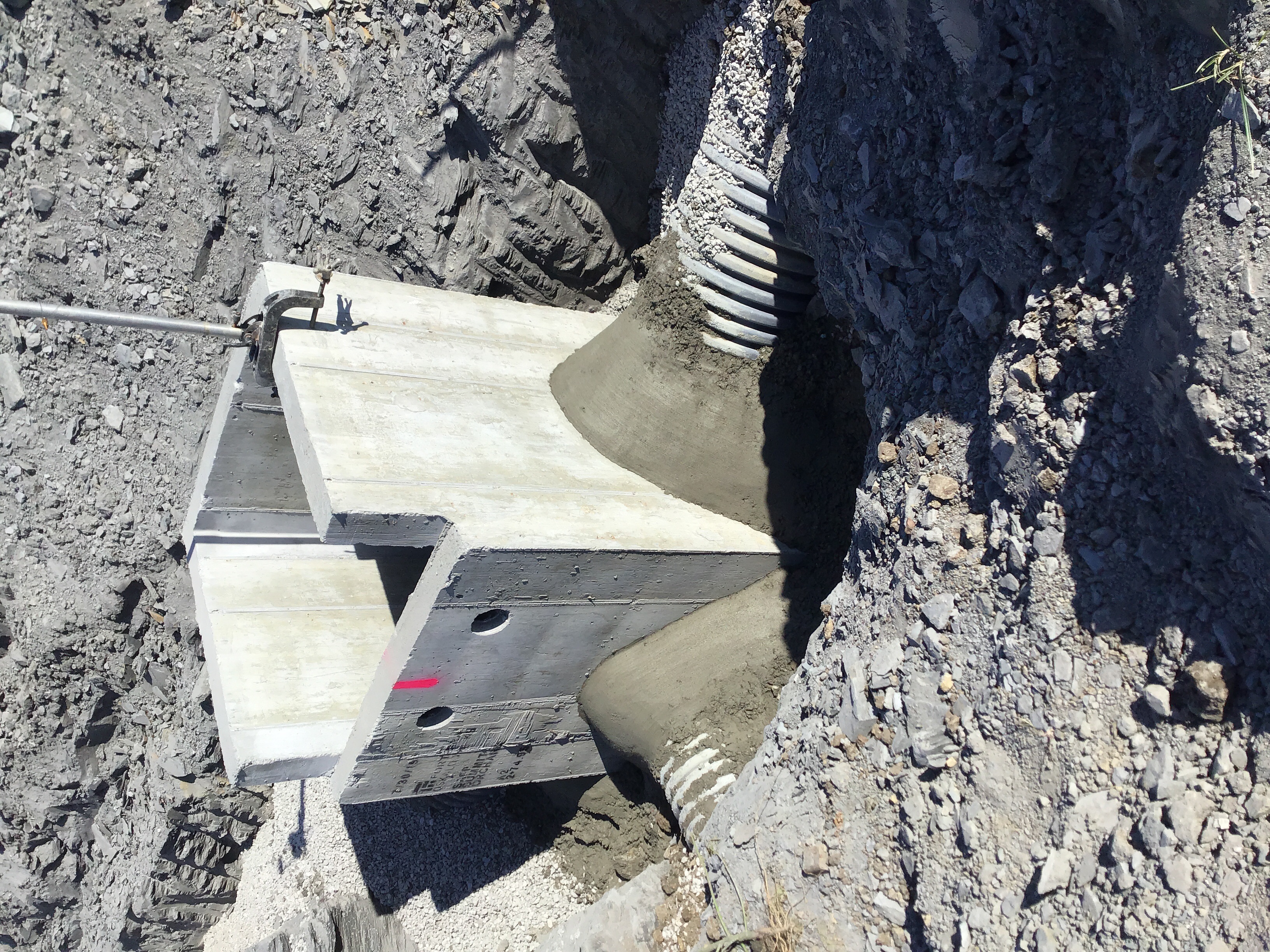

8-14-19 9:14am Box A-3 and B-1 are in and they are pouring collars right now. They are installing 15” storm along Chipman as well.
Misc
Informational
08/15/2019
8-15-19 9:15am They are installing storm pipe along Chipman RD. They have 16 feet installed and are close to setting a box F-1. 2:20pm They have installed approximately 25 additional feet and box F-1. They have poured collars and backfilled with rock.
Pavement-Proof Roll Passed 10/18/2019
Pavement-Stabilized Subgrade Passed 10/18/2019
Misc
Informational
09/10/2019
9-4-19 They are installing geogrid and laying base rock. 2:08pm They have approximately 400 feet of base placed. I will be getting the rock tickets from Bill.
Misc
Corrective Action Required
09/10/2019
On 9-7-19 They were cutting grade for the turn lane on Chipman. They will be laying base rock on monday the 9th.
Misc
Informational
09/10/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/10/2019
9-9-19 They are doing some grading around the west side of the site.
Misc
Informational
09/10/2019
9-9-19 They are working on the grade on the south side along Chipman. I collected base rock tickets from Bill.
Misc
Informational
09/10/2019
9-10-19 2:41pm They are installing base rock in the turning lane on Chipman. The turning lanes on Ward Rd have geogrid and base rock laid. Approximately 400 ton was laid today. They will be trimming base rock later.
Street - Concrete Passed 10/18/2019
Misc
Informational
10/03/2019
9-25-19 7:20am They are setting up for 9am pours on each end of the site. 3:10pm They have poured at the east, west, and south side of the site. The cure was light so I am having them add more.
Misc
Informational
10/03/2019
9-20-19 10:39am They have poured the turn lane on Ward and are working on setting up hand pours.
Misc
Informational
10/03/2019
9-24-19 7:35am They have four hand pours set up. Baskets and bars are in place and they are pouring the north end on The N S road at this time. Terracon is on site for testing.9:36am They are now setting up to pour more of the turn lane coming off Chipman.2:57pm They are finishing up with hand pours and curing, they will begin setting up for more hand pours for tomorrow.
Misc
Informational
10/03/2019
9-26-19 The crew are setting up the approach on the west side of the site. They have concrete coming at 9:30am and will be pouring the approache at the east end first. 3:37pm They are donbe with there hand pours and will be settin g up for pours tomorrow. i spoke with the Forman about up coming curb pours.
Misc
Informational
10/03/2019
9-27-19 They are setting up the turn lane on Ward rd. We will proof roll it Monday.
Misc
Informational
10/03/2019
9-30-19 9:04am The approache at Chipman needs some corrections then can be poured in the afternoon. 1:18pm They have poured the approache coming off Chipman and are working on inlets on the east west road.
Misc
Informational
10/03/2019
10-1-19 They have poured the turn lane on Ward and it is cured. They are working on setting up inlets and pouring them. A second crew are setting up the ten foot wide sidewalk along Ward Rd. They will be pouring it on 10-2-19.
Misc
Informational
10/03/2019
10-2-19 3:17pm They have poured storm inlets and are setting up for sidewalk.
Misc
Informational
10/03/2019
10-3-19 They are pouring the curb in the turning lane on Ward Rd.
Street - Concrete Passed 10/18/2019
Pavement-Curb Construction Passed 10/18/2019
Misc
Informational
10/14/2019
10-14-19 7:55am They are getting ready to pour the curb on the turn lane on Ward rd. with the paver. Terraacon is on site for testing. They have poured the curb and used white cure.
Sidewalk Inspection Partial 10/24/2019 10/24/2019
Misc
Informational
10/17/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/17/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/17/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/17/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/17/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Misc
Informational
10/17/2019
10-17-19 9:01am The storm box at Ward and Chipman will be in the shared use path and it is not ADA compliant. We are working on a solution. The signal box will be lowered to meet ADA spec as well.
Misc
Informational
10/24/2019
10-24-19 9:10am They are pouring the sidewalk along Chipman from Donavon to the turn in for the site. Aggregate is compacted and forms are set to ADA spec at this time.
Sidewalk Inspection Partial 10/25/2019 10/25/2019
Misc
Informational
10/24/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/24/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/24/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/24/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/24/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Misc
Informational
10/24/2019
10-17-19 9:01am The storm box at Ward and Chipman will be in the shared use path and it is not ADA compliant. We are working on a solution. The signal box will be lowered to meet ADA spec as well.
Misc
Informational
10/24/2019
10-24-19 9:10am They are pouring the sidewalk along Chipman from Donavon to the turn in for the site. Aggregate is compacted and forms are set to ADA spec at this time.
Misc
Informational
10/25/2019
10-25-19 The sidewalk has been poured and is in spec. There are two ADA ramps that will need checked later.
Sidewalk Inspection Partial 10/28/2019 10/29/2019
Misc
Informational
10/25/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/25/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/25/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/25/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/25/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Misc
Informational
10/25/2019
10-17-19 9:01am The storm box at Ward and Chipman will be in the shared use path and it is not ADA compliant. We are working on a solution. The signal box will be lowered to meet ADA spec as well.
Misc
Informational
10/25/2019
10-24-19 9:10am They are pouring the sidewalk along Chipman from Donavon to the turn in for the site. Aggregate is compacted and forms are set to ADA spec at this time.
Misc
Informational
10/25/2019
10-25-19 The sidewalk has been poured and is in spec. There are two ADA ramps that will need checked later.
Misc
Informational
10/29/2019
10-29-19 10:41am I spoke with Bill about the sidewalk at Ward and Chipman needing to be cut out by the storm box lid. He said that it should be done this week.
Sidewalk Inspection Passed 11/01/2019
Misc
Informational
10/29/2019
10-3-19 7:30am They are pouring sidewalk along Chipman Rd. The forms are set to 6” and the aggregate was compacted. 9:27am They are covering the sidewalk with plastic it is raining lightly. The sidewalk is poured and cured. They are setting up more sidewalk for tomorrow.
Misc
Informational
10/29/2019
10-4-19 They are pouring approximately 350 feet of sidewalk along Chipman road. It does have ADA crossing.
Misc
Informational
10/29/2019
10-7-19 3:23pm They have set up a ADA ramp at the south east side of the site and are working on one on the north west side of the site.
Misc
Informational
10/29/2019
4:06pm They are pouring the sidewalk on the east end of the site and a section along Chipman. They were having issues with their ADA dome’s. We have found a solution. I told them to use a good even amount of white cure.
Misc
Informational
10/29/2019
10-15-19 9:30am They are setting up sidewalk at the corner of Ward and Chipman, and a section at Chipman and Donavon.
Misc
Informational
10/29/2019
10-17-19 9:01am The storm box at Ward and Chipman will be in the shared use path and it is not ADA compliant. We are working on a solution. The signal box will be lowered to meet ADA spec as well.
Misc
Informational
10/29/2019
10-24-19 9:10am They are pouring the sidewalk along Chipman from Donavon to the turn in for the site. Aggregate is compacted and forms are set to ADA spec at this time.
Misc
Informational
10/29/2019
10-25-19 The sidewalk has been poured and is in spec. There are two ADA ramps that will need checked later.
Misc
Informational
10/29/2019
10-29-19 10:41am I spoke with Bill about the sidewalk at Ward and Chipman needing to be cut out by the storm box lid. He said that it should be done this week.
Site Visit Partial 1/27/2020 01/27/2020
Misc
Informational
10/11/2019
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
10/11/2019
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
10/11/2019
8-21-19 11:18am There is no activity on site.
Misc
Informational
10/11/2019
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
10/11/2019
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
10/11/2019

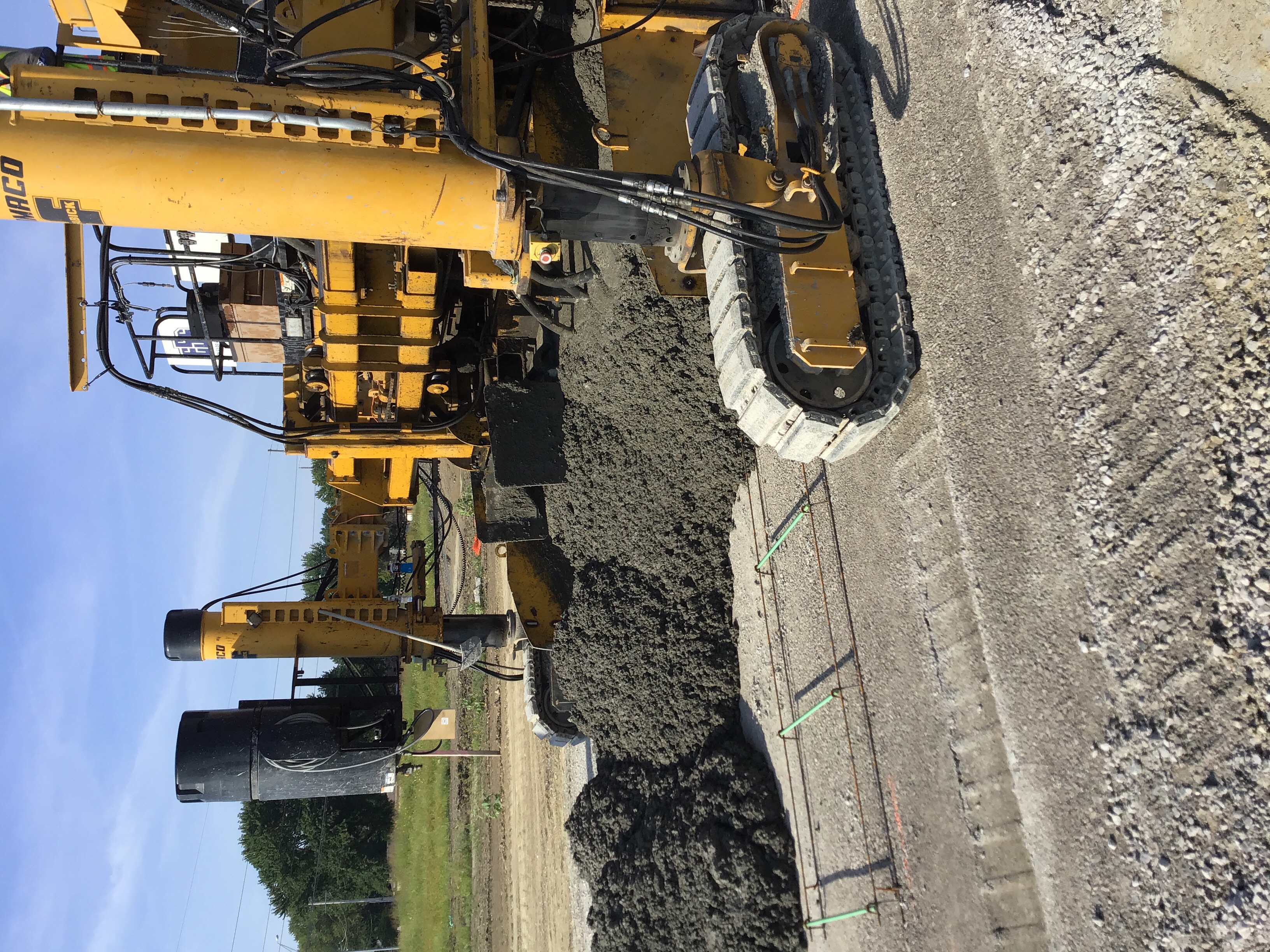

8-29-19 There was a operator on site working on grade.
Misc
Informational
10/11/2019
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
10/11/2019
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
10/11/2019
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
10/11/2019
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
10/11/2019
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
10/11/2019
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Misc
Informational
01/27/2020
1-27-20 I met with Bill on site to give him the Storm Plan And Profile for Lot 4.
Site Visit Partial 1/31/2020 01/31/2020
Misc
Informational
01/27/2020
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
01/27/2020
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
01/27/2020
8-21-19 11:18am There is no activity on site.
Misc
Informational
01/27/2020
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
01/27/2020
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
01/27/2020
8-29-19 There was a operator on site working on grade.
Misc
Informational
01/27/2020
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
01/27/2020
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
01/27/2020
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
01/27/2020
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
01/27/2020
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
01/27/2020
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Misc
Informational
01/27/2020
1-27-20 I met with Bill on site to give him the Storm Plan And Profile for Lot 4.
Misc
Informational
01/31/2020
1-31-20 10:11am There is no activity today.
Storm Sewer Construction Inspection Partial 2/3/2020 02/04/2020
Misc
Informational
02/03/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Storm Sewer Construction Inspection Partial 2/4/2020 02/04/2020
Misc
Informational
02/04/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/04/2020

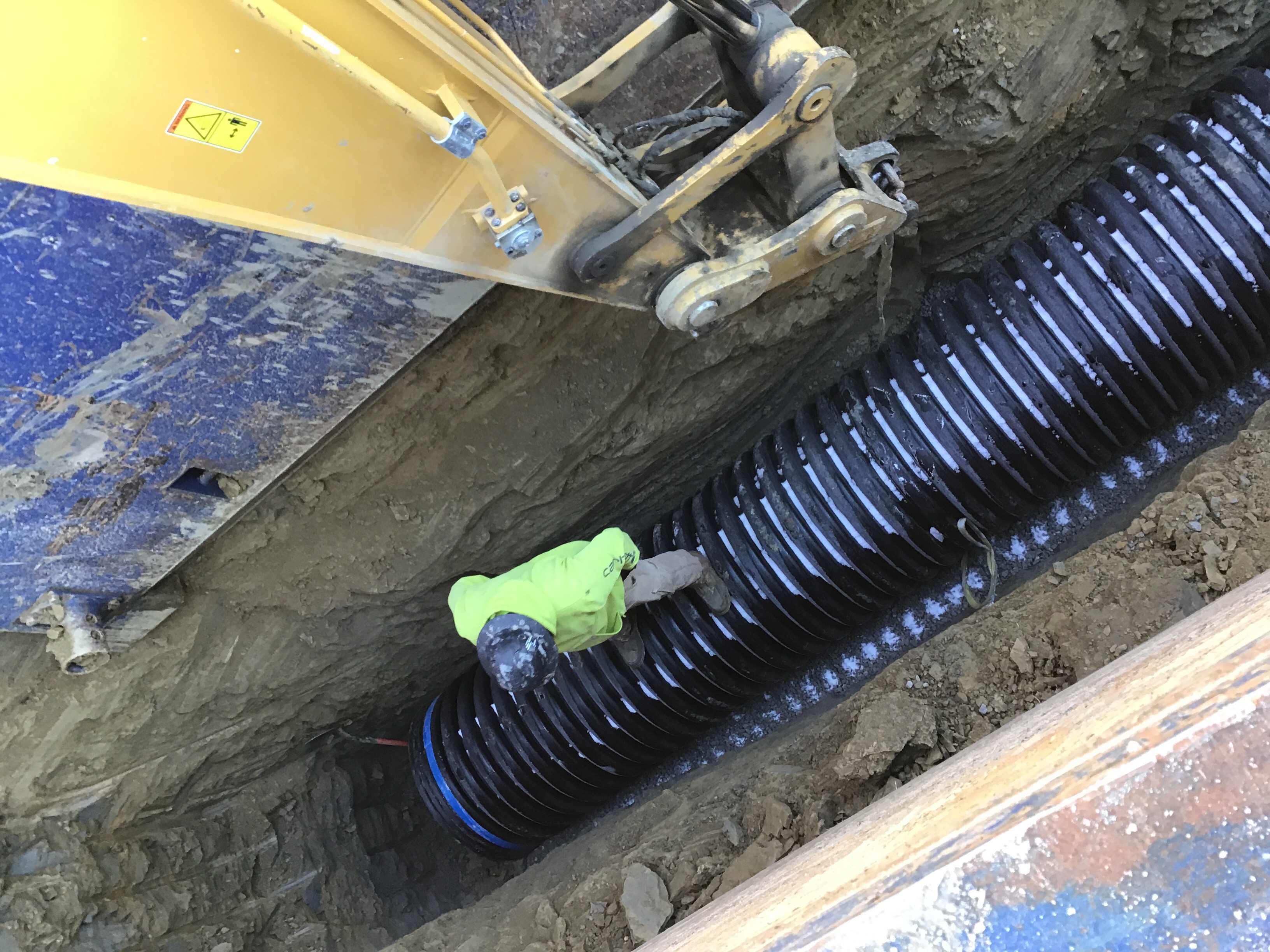

2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Storm Sewer Construction Inspection Partial 2/6/2020 02/06/2020
Misc
Informational
02/04/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/04/2020
2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/06/2020

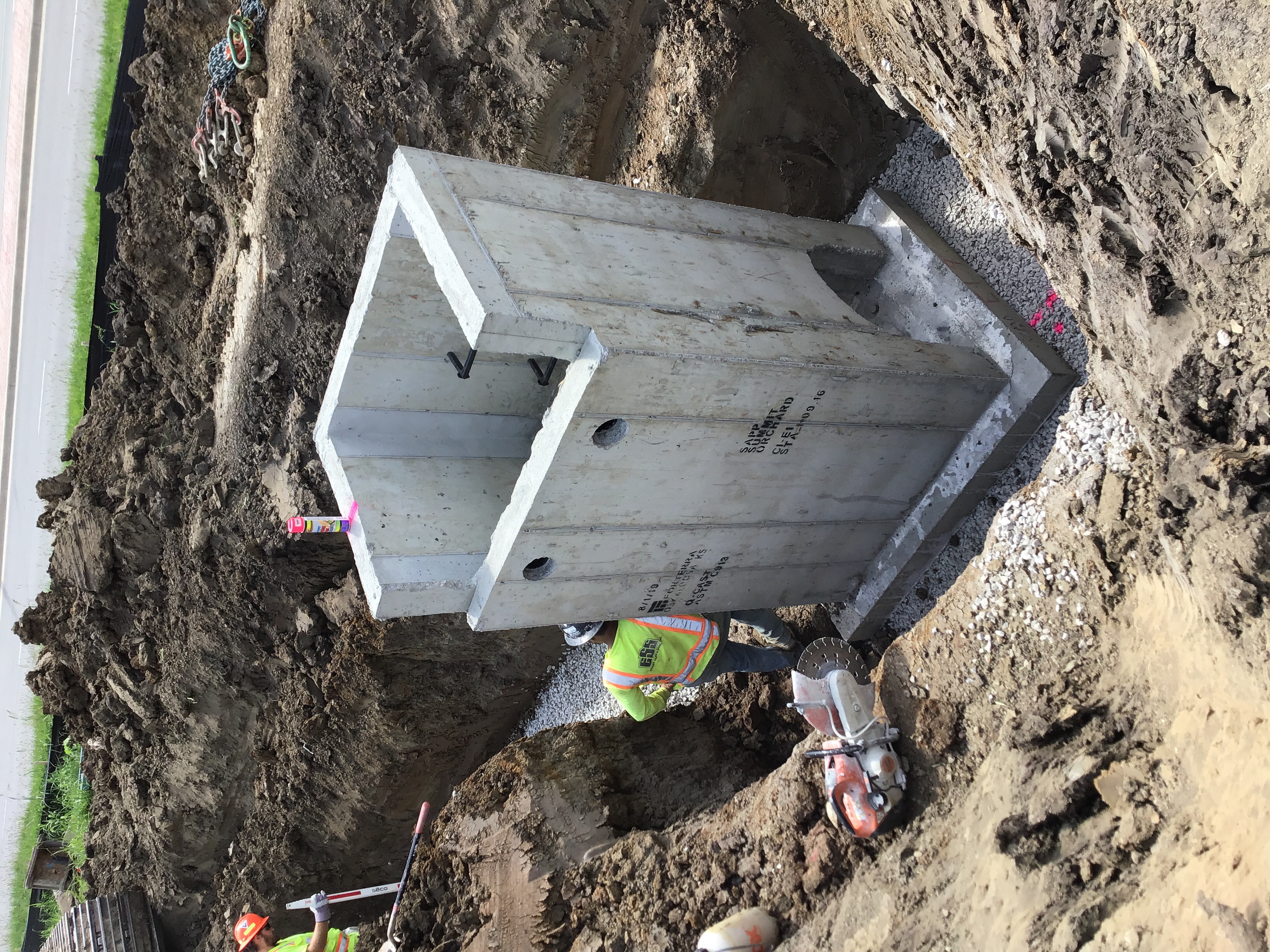

2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/06/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Site Visit Partial 02/07/2020
Misc
Informational
01/31/2020
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
01/31/2020
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
01/31/2020
8-21-19 11:18am There is no activity on site.
Misc
Informational
01/31/2020
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
01/31/2020
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
01/31/2020
8-29-19 There was a operator on site working on grade.
Misc
Informational
01/31/2020
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
01/31/2020
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
01/31/2020
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
01/31/2020
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
01/31/2020
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
01/31/2020
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Misc
Informational
01/31/2020
1-27-20 I met with Bill on site to give him the Storm Plan And Profile for Lot 4.
Misc
Informational
01/31/2020
1-31-20 10:11am There is no activity today.
Misc
Informational
02/07/2020
2-7-20 9:21am There was a complaint called into City Hall about mud on the roads from this job site. I spoke with the Superintendent and informed him that the streets need cleaned and moving forward to pay close attention to debris on the roadways.
Storm Sewer Construction Inspection Partial 2/7/2020 02/07/2020
Misc
Informational
02/06/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/06/2020
2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/06/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/06/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Misc
Informational
02/07/2020
2-7-20 They have approximately 20’ of storm pipe coming out of box 103 heading to box 102. They are pouring the collars for box 103 and will pour the invert at a later date.
Storm Sewer Construction Inspection Partial 2/7/2020 02/10/2020
Misc
Informational
02/07/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/07/2020

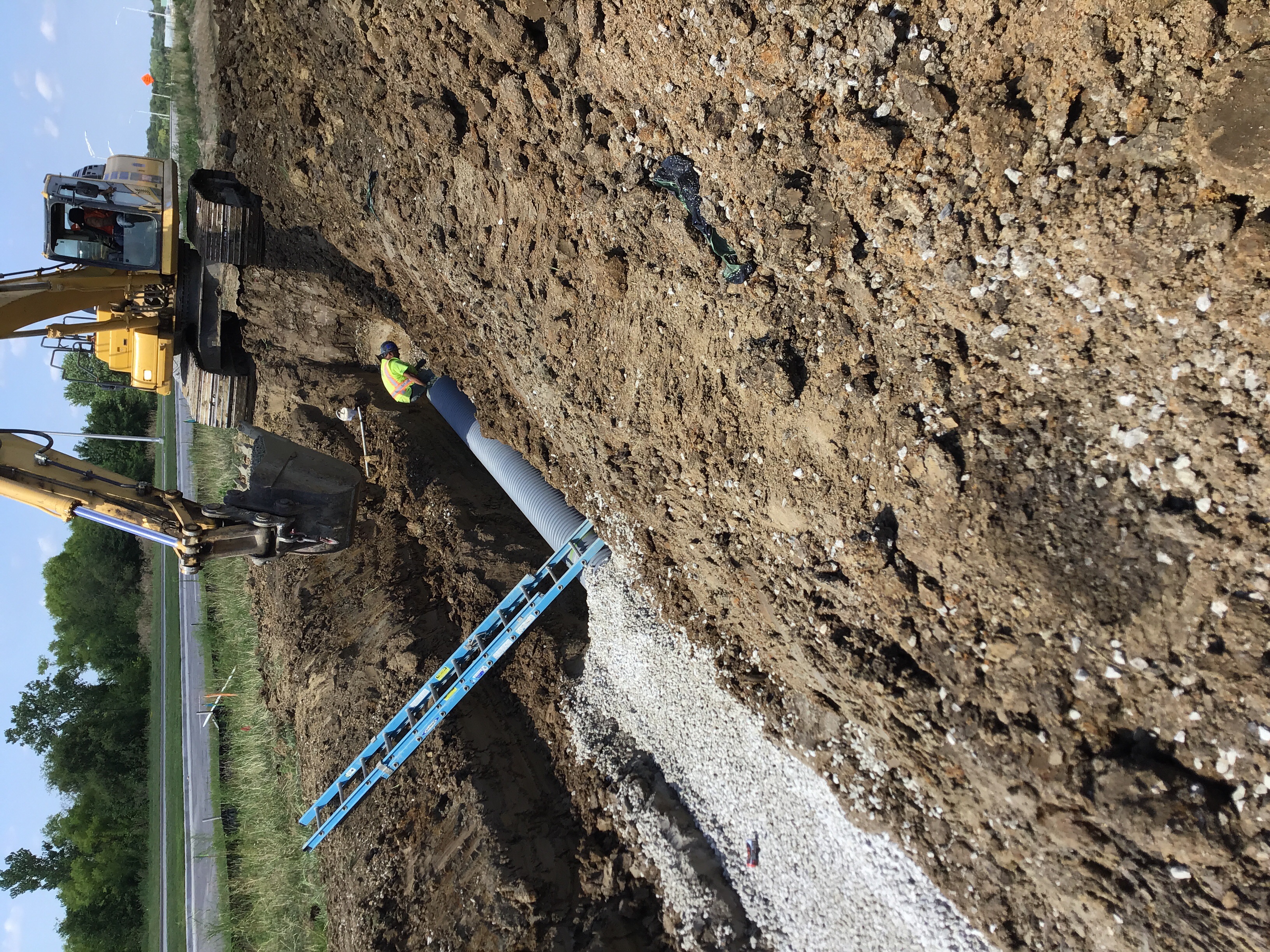

2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/07/2020

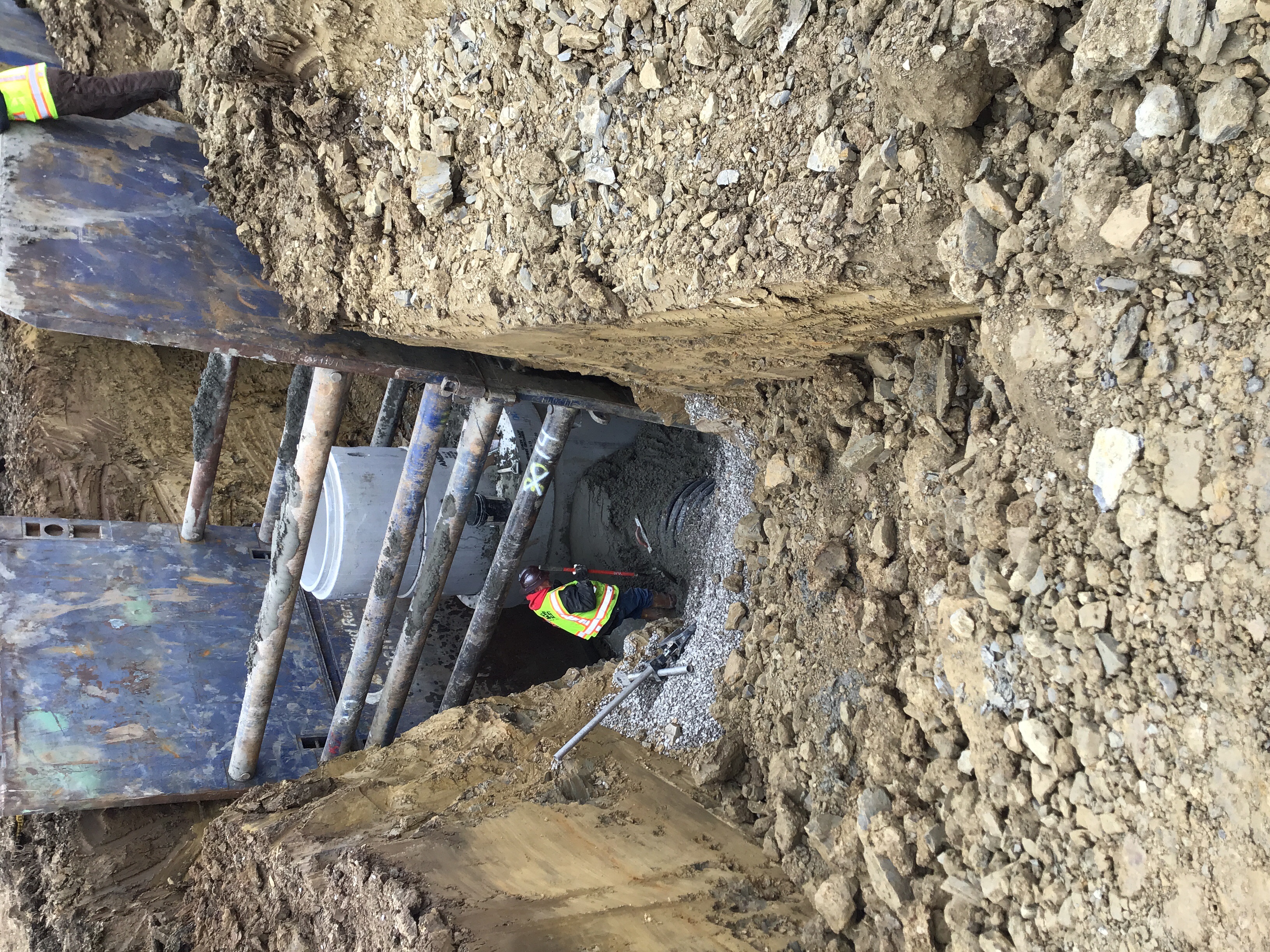

2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/07/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Misc
Informational
02/07/2020
2-7-20 They have approximately 20’ of storm pipe coming out of box 103 heading to box 102. They are pouring the collars for box 103 and will pour the invert at a later date.
Storm Sewer Construction Inspection Partial 2/10/2020 02/10/2020
Misc
Informational
02/10/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/10/2020
2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/10/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/10/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Misc
Informational
02/10/2020
2-7-20 They have approximately 20’ of storm pipe coming out of box 103 heading to box 102. They are pouring the collars for box 103 and will pour the invert at a later date.
Misc
Informational
02/10/2020
2-10-20 8:28am ESS is starting to dig to install more storm pipe. They are pumping out water from storm box 103 to set there laser. 1:27pm They have 2 sticks of storm pipe installed at this time. They are digging out to continue with storm pipe.
Storm Sewer Construction Inspection Partial 2/11/2020 02/11/2020
Misc
Informational
02/10/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/10/2020
2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/10/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/10/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Misc
Informational
02/10/2020
2-7-20 They have approximately 20’ of storm pipe coming out of box 103 heading to box 102. They are pouring the collars for box 103 and will pour the invert at a later date.
Misc
Informational
02/10/2020
2-10-20 8:28am ESS is starting to dig to install more storm pipe. They are pumping out water from storm box 103 to set there laser. 1:27pm They have 2 sticks of storm pipe installed at this time. They are digging out to continue with storm pipe.
Misc
Informational
02/11/2020
2-11-20 8:26am They have installed the 45 number 102 and have approximately 30ft coming out of it heading to box 101. 1:15pm They are placing rock to set box 101.
Site Visit Partial 4/1/2020 04/01/2020
Misc
Informational
02/07/2020
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
02/07/2020
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
02/07/2020
8-21-19 11:18am There is no activity on site.
Misc
Informational
02/07/2020
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
02/07/2020
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
02/07/2020
8-29-19 There was a operator on site working on grade.
Misc
Informational
02/07/2020
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
02/07/2020
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
02/07/2020
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
02/07/2020
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
02/07/2020
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
02/07/2020
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Misc
Informational
02/07/2020
1-27-20 I met with Bill on site to give him the Storm Plan And Profile for Lot 4.
Misc
Informational
02/07/2020
1-31-20 10:11am There is no activity today.
Misc
Informational
02/07/2020
2-7-20 9:21am There was a complaint called into City Hall about mud on the roads from this job site. I spoke with the Superintendent and informed him that the streets need cleaned and moving forward to pay close attention to debris on the roadways.
Misc
Informational
04/01/2020
4-1-20 There are no inspections for this site at this time.
Storm Sewer Construction Inspection Passed 04/22/2020
Misc
Informational
02/11/2020
2-3-20 8:50am SAPP is on site getting equipment ready and are waiting for storm boxes to be delivered. SAPP said they will be starting work on 2-4-20.
Misc
Informational
02/11/2020
2-4-20 9:04am They are digging down to find the existing storm pipe. 3:36pm They have dug down and made cuts. They are hoping to set box 1004 at station 4+00.
Misc
Informational
02/11/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104.
Misc
Informational
02/11/2020
2-6-20 They have box 104 set and the invert and collars are poured. Steve Robbins inspected this on 2-5-20. Today 2-6-20 They have a total of 3 sticks installed coming out of box 104. 2:50pm They have box 103 set and approximately 91ft of pipe installed.
Misc
Informational
02/11/2020
2-7-20 They have approximately 20’ of storm pipe coming out of box 103 heading to box 102. They are pouring the collars for box 103 and will pour the invert at a later date.
Misc
Informational
02/11/2020
2-10-20 8:28am ESS is starting to dig to install more storm pipe. They are pumping out water from storm box 103 to set there laser. 1:27pm They have 2 sticks of storm pipe installed at this time. They are digging out to continue with storm pipe.
Misc
Informational
02/11/2020
2-11-20 8:26am They have installed the 45 number 102 and have approximately 30ft coming out of it heading to box 101. 1:15pm They are placing rock to set box 101.
Misc
Informational
04/22/2020
All storm work is complete.
Install Street and Stop Signs Passed 04/22/2020
Site Visit Complete 11/17/2020
Misc
Informational
04/01/2020
8-23-19 I spoke with the Super and they are just moving dirt right now.
Misc
Informational
04/01/2020
8-22-19 I spoke with Bill the Super on site about street light wires exposed and spliced. They found it that way and it gets removed and new wire goes in.
Misc
Informational
04/01/2020
8-21-19 11:18am There is no activity on site.
Misc
Informational
04/01/2020
8-26-19 8:43am There is no activity on site other than silt fence repair.
Misc
Informational
04/01/2020
8-28-19 Sapp are having there sanitary line camera inspected. This will be followed up 2with a camera inspection from are water department after 30 days from the repair.
Misc
Informational
04/01/2020
8-29-19 There was a operator on site working on grade.
Misc
Informational
04/01/2020
8-30-19 9:58am Rain. There is no activity on the site due to weather.
Misc
Informational
04/01/2020
9-13-19 3:08pm They are placing baskets for the concrete pour and moving equipment around.
Misc
Informational
04/01/2020
9-17-19 8:55am They are cutting grade for the east west road to set up for the south lane pour.
Misc
Informational
04/01/2020
9-18-19 The Sapp crew are laying out for baskets and prepping for concrete pour tomorrow.
Misc
Informational
04/01/2020
9-23-19 They are working on setting up hand poures at the west end of the site.
Misc
Informational
04/01/2020
10-8-19 Jerry and I met and talked with Jonathan, Bill from SAPP and the crew that are installing the private lights along the east west road. They were concerned about placement of the bases. Jonathan said they would be good were they are staked out to go.
Misc
Informational
04/01/2020
1-27-20 I met with Bill on site to give him the Storm Plan And Profile for Lot 4.
Misc
Informational
04/01/2020
1-31-20 10:11am There is no activity today.
Misc
Informational
04/01/2020
2-7-20 9:21am There was a complaint called into City Hall about mud on the roads from this job site. I spoke with the Superintendent and informed him that the streets need cleaned and moving forward to pay close attention to debris on the roadways.
Misc
Informational
04/01/2020
4-1-20 There are no inspections for this site at this time.
Documents & Images
Date Uploaded File Type Document Name
08/05/2019 Storm box c913
08/05/2019 Storm pipe ward
08/05/2019 Letter INSPECTION SUMMARY
09/12/2019 Pumping Chipman n s road
09/12/2019 Pumping west inlet
06/25/2019 Letter DE-Permit
06/21/2019 Receipt Receipt for transaction: 2019-004007
06/21/2019 Receipt Receipt for transaction: 2019-004007
09/19/2019 Concrete ticket0
09/24/2019 North end of N S road
09/24/2019 Turn in off Chipman
09/19/2019 Paver on Chipman
09/19/2019 Chipman turn lane prep
09/17/2019 West end of the site subgrade repair
09/16/2019 Concrete ticket
09/16/2019 Chipman turn lane
09/16/2019 North south road
09/16/2019 Road pour 2
01/15/2020 Receipt Receipt for transaction: 2020-000192
09/16/2019 Road pour
02/06/2020 .jpg
02/06/2020 Storm box
08/30/2019 Letter INSPECTION SUMMARY
02/10/2020 Letter DE-Daily Inspection Summary
08/30/2019 Letter INSPECTION SUMMARY
08/15/2019 Storm pipe along chipman
08/13/2019 C1 collar
08/13/2019 A2 collars poured
08/13/2019 A1 box collar poured
08/09/2019 A-1 box east side
08/09/2019 Letter INSPECTION SUMMARY
08/08/2019 E-4 collars
08/08/2019 Box E-3 collar
08/06/2019 Letter INSPECTION SUMMARY
08/06/2019 Storm pipe E-2 E-3
08/06/2019 Storm E-1 to E-2
09/19/2019 Chipman turn lane0
09/25/2019 East end Donavon
09/19/2019 Paver east west road
09/19/2019 East end pavement
04/01/2020 Letter INSPECTION SUMMARY
10/01/2019 Turn lane on Ward
10/02/2019 Sidewalk on Ward
10/02/2019 Sidewalk ward rd
10/31/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
10/31/2019 Letter DE-Punch List
10/31/2019 Summit Orchards Lot 4- Private Substantial Completion
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
02/04/2020 Letter DE-Daily Inspection Summary
02/07/2020 Collar on 103
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/01/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
04/22/2020 Letter INSPECTION SUMMARY
11/17/2020 Letter DE-Certificate of Final Acceptance (Commercial)
11/17/2020 Letter Summit Orchard Commercial 2nd Plat Lot 4 Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
