Permit Application Status

PRSITE20171319


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSITE20171319
Development - Site
Final Acceptance
LBP V LLC
DEVELOPMENT COMPLETE
Full site development for commercial building
04/27/2017
05/19/2017
02/04/2020
Locations
Contacts
LBP V LLC, Address:3215 NE CARNEGIE DR STE 200, Phone:(816) 795-8100
DAVIDSON ARCHITECTURE & ENGINEERING, Address:4301 INDIAN CREEK PKWY, Phone:(913) 451-9390
CAPITAL CONSTRUCTION SERVICES LLC, Address:2642 NE HAGAN RD, Phone:(816) 875-0018
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 04/27/2017 04/27/2017
Nick Lightner
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $237.00 $237.00 Paid 05/11/2017
91100C9-Water Insp Fee $1,513.47 $1,513.47 Paid 05/11/2017
9110072-Water Test Fee $200.00 $200.00 Paid 05/11/2017
9110068-Storm Fee $410.58 $410.58 Paid 05/11/2017
9110081-Paved Surface Inspection Fee $10,636.82 $10,636.82 Paid 05/11/2017
9110071-Site Grading Fee $2,661.12 $2,661.12 Paid 05/11/2017
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Passed 6/8/2017 08/21/2017
Site Visit Partial 8/22/2017 at 1:10 PM 08/22/2017
Erosion Control Inspection Partial 8/22/2017 at 1:10 PM 08/22/2017
Site Visit Partial 8/24/2017 at 9:01 AM 08/24/2017
Site Visit Partial 8/28/2017 at 2:21 PM 08/28/2017
Site Visit Partial 9/7/2017 at 1:55 PM 09/07/2017
Site Visit Partial 9/19/2017 at 1:50 PM 09/19/2017
Erosion Control Inspection Partial 9/25/2017 at 1:30 PM 09/25/2017
Site Visit Partial 9/26/2017 at 1:27 PM 09/26/2017
Sanitary Sewer Construction Inspection Partial 9/27/2017 at 7:20 AM 09/27/2017
Informational
09/27/2017
Matt Munger 09/27/2017 3:14 PM Spoke with Kevin Carr in regards to the sewer service line install. Plans were not matching the approved set that I had. Bart contacted Chad Holthouse in regards to make sure they get the revised set of plans. I called Chad Holthouse before I left to introduce myself and inform him that I would be taking over the project for Bart.
Sanitary Sewer Construction Inspection Partial 9/27/2017 at 2:31 PM 09/27/2017
Informational
09/27/2017
Matt Munger 09/27/2017 3:22 PM The crew had connected the sewer service line to the building and put in the majority of the sewer service line.
Sanitary Sewer Construction Inspection Partial 9/28/2017 at 9:01 AM 09/28/2017
Informational
09/28/2017
Matt Munger 09/28/2017 10:48 AM Contractor had sewer line in, trench was backfilled.
Storm - Outlet Structure Partial 9/28/2017 at 9:22 AM 09/28/2017
Informational
09/28/2017
Matt Munger 09/28/2017 10:59 AM Observed the contractor digging the area around the existing inlet up to place the storm junction box in to tie in the existing inlet. Contractor had to make an adjustment to where the pipe is entering going from the junction box to the inlet to avoid having to take out the stairs.
Storm - Outlet Structure Partial 9/29/2017 at 1:00 PM 09/28/2017
Informational
09/28/2017
Matt Munger 09/28/2017 2:36 PM Contractor was prepping area inlet structure 1-0 at Station 0+00.00 to be able to connect the precast junction box 1-1 station 0+13.24. Contractor made adjustment to where the pipe will enter into the structure 1-0 to avoid removing the stairs. Hole was dug for station 0+86.45.
Informational
09/28/2017
Matt Munger 09/28/2017 2:44 PM Informed the contractor that I had setup a test shutdown of the water main that they will be connecting to. Spoke with Evan Dolan from Water and he stated they would have someone out 9/28 or 9/29 to do the test shutdown. Contractor informed me that he would like to shutdown the line on 10/2/17 to tie-in. I informed Evan Dolan of the time that his guys will be needed to perform the shutdown.
Water Line - Construction Inspection Partial 9/29/2017 at 8:00 AM 09/29/2017
Informational
09/29/2017
Matt Munger 09/29/2017 3:35 PM Water Utilities workers performed the test shutdown. They were not successful in shutting down the 12" main. I notified Keith that we would not be able to do the shutdown on 10/2/17. I also informed Keith that once we know that we can do the shutdown that they need to notify the customers that will be out of service 24 hours prior to the shutdown.
Site Visit Partial 9/29/2017 at 2:07 PM 09/29/2017
Informational
09/29/2017
Matt Munger 09/29/2017 3:42 PM I informed Kevin that the test shutdown was not successful and that once we know when we can do the shutdown that he would need to notify the customers that would be affected by the shutdown 24 hours in advance.
Erosion Control Inspection Partial 9/28/2017 at 2:02 PM 09/29/2017
Informational
09/29/2017
Matt Munger 09/29/2017 3:53 PM On 9/28/17 I had observed several sections of the silt fence along Jones Indsutrial Rd and Independence Ave that have fallen down.
Water Line - Construction Inspection Partial 10/5/2017 at 7:20 AM 10/03/2017
Informational
10/03/2017

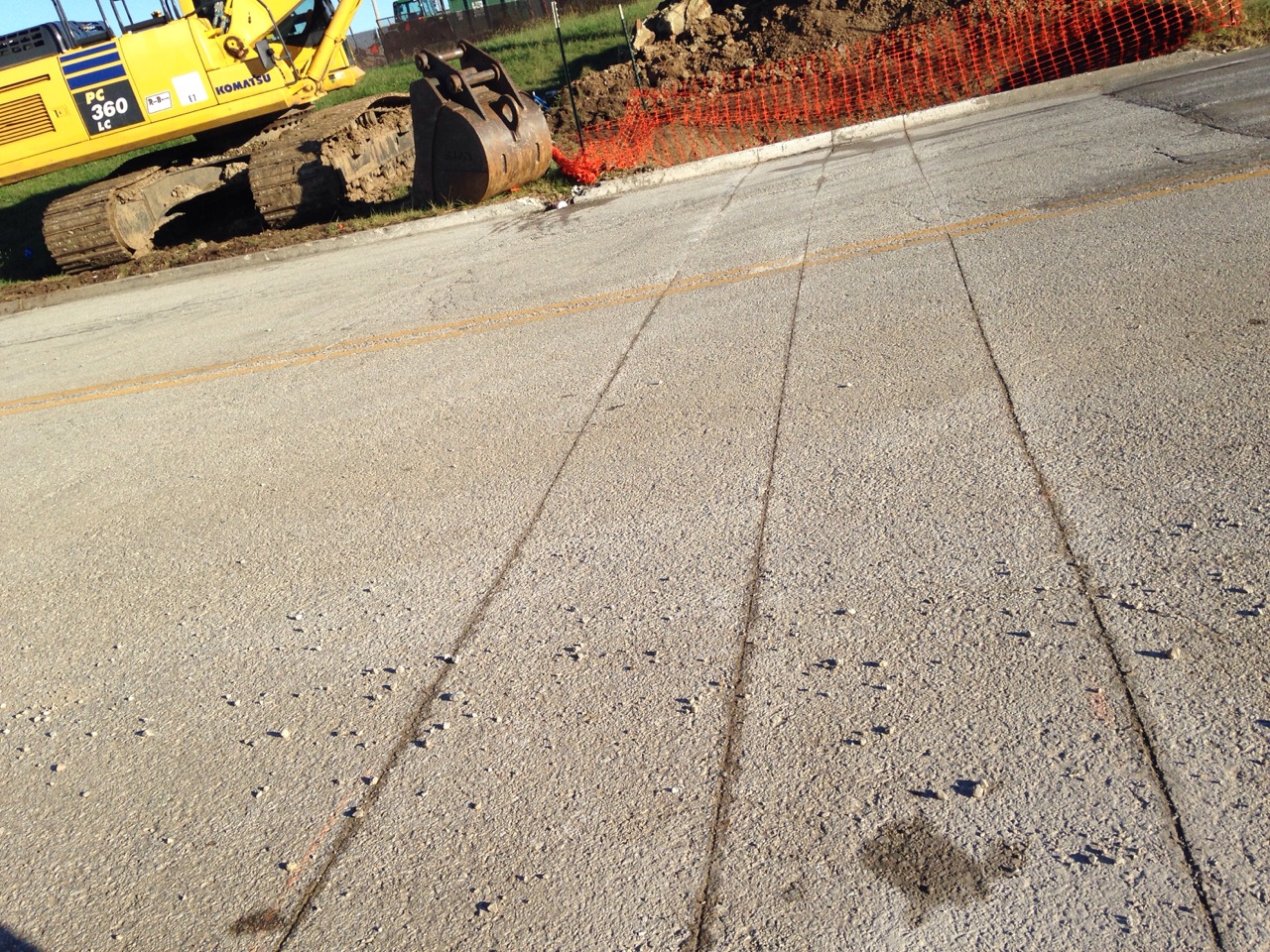

Jones Industrial Rd. has been saw cut. Jones Indus. was saw cut for the fire line and domestic service line. City has not approved a street cut. Notified Chad Holthouse that the water lines (fire and domestic service) must be bored under the road.
Water Line - Construction Taps Removed Partial 10/3/2017 at 8:45 AM 10/03/2017
Corrective Action Required
10/03/2017
Matt Munger 10/03/2017 12:55 PM Observed Kevin and his crew putting in the private water line. As I was checking the parts that were present I made sure to inform Kevin that the Hydrant needed to the correct color for a private line (yellow with a silver bonnet) as well as making sure the Hydrant was on the approved parts list. The brand was correct but the model was not. I wrote down the info Kevin needed to make sure he gets the correct Hydrant.
Informational
10/03/2017
Matt Munger 10/03/2017 12:59 PM I observed Kevins crew put in tracer wire and I picked up a concrete ticket for the the thrust blocks he was pouring. I informed Kevin that the plactic he was using to wrap the joints etc. has to be clear and 12 mils thick.
Site Visit Partial 10/3/2017 at 11:41 AM 10/03/2017
Informational
10/03/2017
Matt Munger 10/03/2017 1:07 PM Picked up concrete ticket.
Site Visit Partial 10/4/2017 at 10:41 AM 10/04/2017
Informational
10/04/2017
Matt Munger 10/04/2017 11:43 AM No workers were present. Construction entrance will need to cleaned up and the gravel on the road. I contacted Kevin and informed him about the condition of the entrance.
Water Line - Fire Hydrant Partial 10/4/2017 at 10:41 AM 10/04/2017
Informational
10/04/2017
Matt Munger 10/04/2017 11:47 AM I observed blue tracer wire along the service line up the fire hydrant, fittings and valve were wrapped with clear plastic as well as up to the fire hydrant. Concrete base plate was under the hydrant.
Site Visit Partial 10/5/2017 at 9:24 AM 10/05/2017
Informational
10/05/2017
Matt Munger 10/05/2017 9:40 AM No workers were present. Gravel on roadway was cleaned up.
Erosion Control Inspection Failed 10/6/2017 at 11:20 AM 10/06/2017
PW-Erosion and Sediment Control
Corrective Action Required
10/06/2017
Matt Munger 10/06/2017 2:37 PM Your project is in violation of the Erosion and Sediment control policy. Silt fence is not intact according to the plans around the site. There is no protection around the storm inlets. ESC devices need to be maintained throughout the duration of the project.
Site Visit Partial 10/10/2017 at 9:23 AM 10/10/2017
Informational
10/10/2017
Matt Munger 10/10/2017 9:31 AM No workers were present due to weather.
Site Visit Partial 10/11/2017 at 9:28 AM 10/11/2017
Informational
10/11/2017
No workers were present, I observed locates in place along both sides of the NE Jones Industrial Rd. Silt fences are still down and Storm Inlet devices will need to be put in place. I contacted Kevin on 10/10/17 in regards to Erosion Control issues and he stated they will get to it this week. Matt Munger 10/11/2017 9:45 AM
Site Visit Partial 10/12/2017 at 2:26 PM 10/12/2017
Informational
10/12/2017
Matt Munger 10/12/2017 2:34 PM No workers present.
Site Visit Partial 10/13/2017 at 9:30 AM 10/13/2017
Informational
10/13/2017
When I arrived I observed Kevin and his crew digging to get ready for the bore company on the south side of the road. He stated they wouldn't be able to bore today. Spoke with Kevin about putting up silt fences and devices around the storm inlets, he stated they were waiting on the materials but would get it taken care of. Matt Munger 10/13/2017 3:02 PM
Site Visit Partial 10/16/2017 at 9:01 AM 10/16/2017
Informational
10/16/2017
No workers were present. The water pipe that was on site was ANSI/AWWA C900 6" and a PC 235. Matt Munger 10/16/2017 9:17 AM
Erosion Control Inspection Partial 10/16/2017 at 2:11 PM 10/16/2017
Informational
10/16/2017
The storm inlets have material in place to prevent silt from getting into the storm sewer. West side of the site needs a silt fence in place. Matt Munger 10/16/2017 2:20 PM
Site Visit Partial 10/17/2017 at 10:30 AM 10/17/2017
Site Visit Partial 10/18/2017 at 9:56 AM 10/18/2017
Informational
10/18/2017
Spoke with Kevin in regards to the progress on the street bore. He stated it was taking longer than expected, so we decided to re-schedule the shutdown to tie-in to the main on 10/25/17 at 7:15am. I informed Kevin of the parts needed and about the Chlorination process as well to make sure we have a valve on the Tee per the D&C. Matt Munger 10/18/2017 10:33 AM
Backflow Preventer and Vault Partial 10/19/2017 at 7:45 AM 10/19/2017
Informational
10/19/2017
Matt Munger 10/19/2017 9:34 AM Observerd workers installing the BFP in the vault. I reminded the workers as well as Chad H. about using the 3M Rubberized Spray on all bolts.
Fire Line Construction Inspection Partial 10/19/2017 at 2:25 PM 10/19/2017
Informational
10/19/2017
Matt Munger 10/19/2017 2:52 PM I observed tracer wire on the water line the clear plastic wrap for the fittings. I spoke with Pat in regards to the dirt on the north side in the curb and asked that they clean that up.
Fire Line Construction Inspection Partial 10/20/2017 at 7:00 AM 10/20/2017
Informational
10/20/2017
Matt Munger 10/20/2017 4:03 PM I observed the workers black bag the hydrants that were going to be out of service. Prior to the installation the workers swabbed the fittings and inside of the pipes with bleach. They also used the 3M Rubberized Spray on the bolts on the fittins as well as wrap the fittings and valve. Water Utilities workers controlled the valves and performed the flush. They got a chlorine reading of 1.95 after the flush.
Fire Line Construction Inspection Partial 10/20/2017 at 1:16 PM 10/20/2017
Site Visit Partial 10/23/2017 at 10:31 AM 10/23/2017
Backflow Preventer and Vault Partial 10/24/2017 at 9:39 AM 10/24/2017
Informational
10/24/2017
Matt Munger 10/24/2017 10:26 AM Contractors were backfilling the trench where they had put in the fire line.
Miscellaneous PWORKS Inspection Partial 10/24/2017 at 2:00 PM 10/24/2017
PW-Misc
Informational
10/24/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
Sanitary Sewer Construction Inspection Passed 10/26/2017 10/26/2017
Informational
10/26/2017
Matt Munger 10/26/2017 9:10 AM Sanitary sewer line was installed and completed back in September.
Site Visit Partial 10/26/2017 at 9:30 AM 10/26/2017
PW-Misc
Informational
10/24/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
10/26/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
Pavement-Aggregate Base Partial 10/26/2017 at 2:26 PM 10/26/2017
PW-Misc
Informational
10/26/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
10/26/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
Informational
10/26/2017
Matt Munger 10/26/2017 3:01 PM I observed the Contractors compacting the soil using a Vibratory Machine Roller. They had gravel spread out by the docking bays and were rolling/compacting the gravel.
Pavement-Aggregate Base Partial 10/27/2017 at 1:11 PM 10/27/2017
PW-Misc
Informational
10/26/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
Informational
10/27/2017
Observed the workers clearing the areas where the pavement will be on the north side of the property as well as compacting the gravel on the west side where the access to the docks are. Spoke with Scott and scheduled the proof roll test for Monday 10/30/17 at 8am for the dock areas. Matt Munger 10/27/2017 1:33 PM
Proof roll parking lot Partial 10/30/2017 at 7:45 AM 10/30/2017
Informational
10/30/2017
Matt Munger 10/30/2017 8:36 AM I observed the dump truck roll back and forth over the Type 5 base material in the three dock areas on the west side of the building. There was an area on the south side (last dock at the end) that dipped down while the truck was rolling over the Type 5 base material. I informed Butch (Walter's Excavating) to fix that area.
Site Visit Partial 10/31/2017 at 9:31 AM 10/31/2017
PW-Misc
Informational
10/31/2017
Matt Munger 10/31/2017 10:41 AM No workers were present. Thrusts blocks need to be poured for the fittings that were used on the water pipe on the north side of Jones Industrial. I informed Kevin on 10/27/17 that the thrusts blocks will need to be poured before we can do any tests on that line.
Site Visit Partial 11/1/2017 at 8:06 AM 11/01/2017
PW-Misc
Informational
10/31/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
10/31/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
PW-Misc
Informational
11/01/2017
Matt Munger 11/01/2017 8:34 AM No worker were present, base material has been put down for paving.
Site Visit Partial 11/3/2017 at 9:11 AM 11/03/2017
PW-Misc
Informational
11/01/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
11/01/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
PW-Misc
Informational
11/01/2017
Matt Munger 11/01/2017 8:34 AM No worker were present, base material has been put down for paving.
PW-Misc
Informational
11/03/2017
Matt Munger 11/03/2017 9:51 AM Keith called and stated they were going to pour thrust blocks for the fittings on the north side of Jones Industrial. They had the rebar in place and waiting on the concrete truck. Kevin asked if they could pressure test the fire line and I informed him that the thrust blocks would need to sit for 24 hours before they can do a pressure test/charge the line. I let Kevin know to call me when the thrust block has been poured so I can visually inspect. We will schedule the pressure test for Monday 11/6/17. I also informed them to make sure there is blocks in place to support the valves in the BFP vault.
Water Line - Thrust Restraint Passed 11/6/2017 at 7:45 AM 11/06/2017
PW-Misc
Informational
11/06/2017
Matt Munger 11/06/2017 8:22 AM Thust block was poured for the fittings north of the road.
Fire Line - Hydrostatic Test Partial 11/6/2017 at 7:45 AM 11/06/2017
PW-Misc
Informational
11/06/2017
Matt Munger 11/06/2017 8:24 AM Pressure test was scheduled for 11/6/17 when I arrived on site no workers were present. Contacted Kieth and he wanted to reschedule for 11/13/17.
Fire Line - Hydrostatic Test Passed 11/8/2017 at 8:25 AM 11/08/2017
PW-Misc
Informational
11/06/2017
Matt Munger 11/06/2017 8:24 AM Pressure test was scheduled for 11/6/17 when I arrived on site no workers were present. Contacted Kieth and he wanted to reschedule for 11/13/17.
PW-Misc
Informational
11/08/2017
Matt Munger 11/08/2017 11:49 AM Contractor flushed the fire line and started the pressure test at 200 psi. Pressure had dropped below 200psi (160psi) so the Contractor tightend some bolts on the valves in the BFP vault and started the test over again. Fire Line held 200 psi for 2 hours. Will be back to chlorinate line 11/13/17 at 9:30 am. Steve Robinson will cover me during that time.
Pavement-Aggregate Base Partial 11/8/2017 at 1:05 PM 11/08/2017
Informational
11/08/2017
Matt Munger 11/08/2017 1:22 PM Contacted Scott about putting down geogrid per the plans. Scott stated they are going to put it down and that there was some confusion but it has been cleared up.
Site Visit Partial 11/13/2017 at 2:21 PM 11/13/2017
PW-Misc
Informational
11/03/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
11/03/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
PW-Misc
Informational
11/03/2017
Matt Munger 11/01/2017 8:34 AM No worker were present, base material has been put down for paving.
PW-Misc
Informational
11/03/2017
Matt Munger 11/03/2017 9:51 AM Keith called and stated they were going to pour thrust blocks for the fittings on the north side of Jones Industrial. They had the rebar in place and waiting on the concrete truck. Kevin asked if they could pressure test the fire line and I informed him that the thrust blocks would need to sit for 24 hours before they can do a pressure test/charge the line. I let Kevin know to call me when the thrust block has been poured so I can visually inspect. We will schedule the pressure test for Monday 11/6/17. I also informed them to make sure there is blocks in place to support the valves in the BFP vault.
PW-Misc
Informational
11/13/2017
Matt Munger 11/13/2017 2:46 PM No workers were present. It did not appear that geogrid was put down yet.
Fire Line - Flush Passed 11/13/2017 11/13/2017
PW-Misc
Informational
11/08/2017
PW-Misc
Informational
11/13/2017
Matt Munger 11/13/2017 4:24 PM Steve Robbins covered me while I was at a doctor's appointment. Steve had the Contractor flush the line and chlorinate. Steve checked the chlorine level with a test strip and it passed.
Site Visit Partial 11/14/2017 11/14/2017
PW-Misc
Informational
11/13/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
11/13/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
PW-Misc
Informational
11/13/2017
Matt Munger 11/01/2017 8:34 AM No worker were present, base material has been put down for paving.
PW-Misc
Informational
11/13/2017
Matt Munger 11/03/2017 9:51 AM Keith called and stated they were going to pour thrust blocks for the fittings on the north side of Jones Industrial. They had the rebar in place and waiting on the concrete truck. Kevin asked if they could pressure test the fire line and I informed him that the thrust blocks would need to sit for 24 hours before they can do a pressure test/charge the line. I let Kevin know to call me when the thrust block has been poured so I can visually inspect. We will schedule the pressure test for Monday 11/6/17. I also informed them to make sure there is blocks in place to support the valves in the BFP vault.
PW-Misc
Informational
11/13/2017
Matt Munger 11/13/2017 2:46 PM No workers were present. It did not appear that geogrid was put down yet.
PW-Misc
Informational
11/14/2017
Matt Munger 11/14/2017 10:06 AM Keith contacted me Tuesday morning and stated his truck broke down and that he would not be able to make it to de-chlorinate the line. I Informed Keith that Blue Valley Labs would have to come in on saturday if we take samples Thursday and Friday and that Blue Valley will charge them $100.00 for having to come in on a Saturday to pull samples. I contacted Blue Valley Labs to see if they could have an employee come in Saturday to pull samples. The lady on phone took my info down and told me they would have the lady that would possibly be in call me Tuesday afternoon.
Site Visit Partial 11/14/2017 at 11:06 AM 11/14/2017
PW-Misc
Informational
11/14/2017
Matt Munger 11/14/2017 11:28 AM No workers present.
Site Visit Partial 11/15/2017 at 8:30 AM 11/15/2017
PW-Misc
Informational
11/14/2017
I drove by and no one was working.Steve Robbins 10/24/2017 3:50 PM
PW-Misc
Informational
11/14/2017
Matt Munger 10/26/2017 1:20 PM Stopped by in the AM and did not see workers present. Contacted Kevin in regards to the fittings on the fire line and informed him to make sure they are wrapped and the thrusts blocks get poured for to restrain the pipe fittings on the north side of the road where they tied in the tee.
PW-Misc
Informational
11/14/2017
Matt Munger 11/01/2017 8:34 AM No worker were present, base material has been put down for paving.
PW-Misc
Informational
11/14/2017
Matt Munger 11/03/2017 9:51 AM Keith called and stated they were going to pour thrust blocks for the fittings on the north side of Jones Industrial. They had the rebar in place and waiting on the concrete truck. Kevin asked if they could pressure test the fire line and I informed him that the thrust blocks would need to sit for 24 hours before they can do a pressure test/charge the line. I let Kevin know to call me when the thrust block has been poured so I can visually inspect. We will schedule the pressure test for Monday 11/6/17. I also informed them to make sure there is blocks in place to support the valves in the BFP vault.
PW-Misc
Informational
11/14/2017
Matt Munger 11/13/2017 2:46 PM No workers were present. It did not appear that geogrid was put down yet.
PW-Misc
Informational
11/14/2017
Matt Munger 11/14/2017 10:06 AM Keith contacted me Tuesday morning and stated his truck broke down and that he would not be able to make it to de-chlorinate the line. I Informed Keith that Blue Valley Labs would have to come in on saturday if we take samples Thursday and Friday and that Blue Valley will charge them $100.00 for having to come in on a Saturday to pull samples. I contacted Blue Valley Labs to see if they could have an employee come in Saturday to pull samples. The lady on phone took my info down and told me they would have the lady that would possibly be in call me Tuesday afternoon.
PW-Misc
Informational
11/15/2017
Matt Munger 11/15/2017 9:24 AM Checked Chlorine level with test strips and the strips turned black right a way. Contractor used granules in a bucket to de-chlorinate till the strips did not turn black.
Pavement-Aggregate Base Partial 11/15/2017 at 10:16 AM 11/15/2017
Informational
11/15/2017
Matt Munger 11/15/2017 10:36 AM I observed the contractor putting base gravel over geogrid that had been put down on the north and east side of the building. The contractor was not sure when they would be ready for a proof roll.
Pavement-Aggregate Base Partial 11/16/2017 at 9:41 AM 11/16/2017
Informational
11/16/2017
Matt Munger 11/16/2017 10:20 AM Contractor has some areas on the west side of the proposed paved area that needs to have geogrid put in place. I observed geogrid in areas that are to be paved on the north and east side and a minimum of 6" of compacted base material over the geogrid. Workers were removing spoils from the site.
Site Visit Partial 11/20/2017 at 10:01 AM 11/20/2017
PW-Misc
Informational
11/20/2017
Matt Munger 11/20/2017 10:35 AM Workers were putting in curb stakes for the entrance. Subgrade base material appears to compacted for the areas that asphalt is required. Will need to perform a proof roll for the curbs and pavement areas before they put down pavement and curbs.
Curb - Proof Roll Passed 11/21/2017 at 1:15 PM 11/21/2017
Site Visit Partial 11/22/2017 at 9:30 AM 11/22/2017
PW-Misc
Informational
11/14/2017
Matt Munger 11/14/2017 11:28 AM No workers present.
PW-Misc
Informational
11/22/2017
Matt Munger 11/22/2017 1:53 PM Workers were installing trash enclosure walls but no other work was being done on site. I had some concerns with the base material appearing to have sunken in by the southwest curb inlet. Talked to Dustin Walters and he stated it shouldn't be an issue since they are going to pour the throat for the curb inlet where I had noticed the low spot. Observed there orange safety fence had fallen down around the hole on the north side of Jones Industrial. Erosion control needs to be worked on for this site particuarly the west side of the site.
Fire Line - Flush Passed 11/27/2017 at 8:30 AM 11/27/2017
PW-Misc
Informational
11/27/2017
Matt Munger 11/27/2017 9:15 AM Line was chlorinate and de-chlorinated prior to this flush but Kevin had vehicle issues so we are flushing the line again and letting it sit for 24 hours then will return to take samples on Tuesday the 28th.
Water Line - Coliform Test 1 Partial 11/28/2017 at 9:41 AM 11/28/2017
PW-Misc
Informational
11/28/2017
Matt Munger 11/28/2017 11:58 AM Took first set of samples 2 from BFP vault and 2 from end of line.
Water Line - Coliform Test 2 Partial 11/29/2017 at 10:00 AM 11/29/2017
PW-Misc
Informational
11/29/2017
Took water samples from the end of the line and from the vault down to the lab.Nick Lightner 11/29/2017 1:28 PM
Site Visit Partial 12/4/2017 at 9:30 AM 12/04/2017
PW-Misc
Informational
12/04/2017
Stopped by to introduce my self and called Scott so that he would have my number. Crew was setting up to pour the approach.
Erosion Control Inspection Failed 12/4/2017 at 9:30 AM 12/04/2017
PW-Devices for Erosion and Sediment Control
Corrective Action Required
12/04/2017
There are problems with the erosion control devices on your site. * ESC fence needs to be added to the W side of the property like the engineering plans call out. I will check back in a few days to see if any thing has been added.Nick Lightner 12/04/2017 1:10 PM
Site Visit Partial 12/5/2017 at 2:45 PM 12/05/2017
PW-Misc
Informational
12/05/2017
Talked to Scott about the erosion control from the W side of the property and he informed me after the grading for the parking lot is done he would put in the silt fence. Talked to the concrete guys and found out when they are pouring the approach. Will check back tomorrow.
Water Line - Coliform Test 2 Failed 12/05/2017
PW-Misc
Corrective Action Required
12/05/2017
Water test from the vault FAILED end of line test passed. Called Chad about re-testing and to let me know when they wanted to re chlorinate the line again.
Site Visit Partial 12/6/2017 at 2:00 PM 12/06/2017
PW-Misc
Informational
12/06/2017
Grabbed the concrete tickets for the approach on the N side and talked to the grading contractor about when he wanted to proof roll and that is going to be tomorrow. Nick Lightner 12/06/2017 3:05 PM
Proof roll parking lot Passed 12/7/2017 at 8:20 AM 12/07/2017
Informational
12/07/2017
Proof Rolled the parking lot this morning with a grader. No movement in the rock. Nick Lightner 12/07/2017 8:42 AM
Erosion Control Inspection Partial 12/8/2017 at 8:50 AM 12/08/2017
Site Visit Partial 12/11/2017 at 10:45 AM 12/11/2017
PW-Misc
Informational
12/11/2017
Poured the base for the parking lot. Ground temp was 37 and rising, air temp was 45 and rising Nick Lightner 12/11/2017 3:56 PM
Site Visit Partial 12/12/2017 at 2:00 PM 12/12/2017
PW-Misc
Informational
12/12/2017
No work going on. No ESC has been put into place. End of this week the process to water test should take place, the water main across the street on the N side needs to be covered. Nick Lightner 12/12/2017 2:16 PM
Driveway Inspection Passed 12/12/2017 at 2:15 PM 12/12/2017
PW-Misc
Informational
12/12/2017
Inspected the cross slope for the driveway approach on the N side of the property. Cross slope passed I did notice that the approach has some divets from them driving over it to pour asphalt yesterday. Nick Lightner 12/12/2017 2:22 PM
Site Visit Partial 12/13/2017 at 2:00 PM 12/13/2017
Water Line - Coliform Test 2 Partial 12/18/2017 at 9:45 AM 12/18/2017
PW-Misc
Informational
12/18/2017
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
Site Visit Complete 12/14/2017 12/18/2017
Water Line - Coliform Test 2 Partial 12/19/2017 at 10:00 AM 12/19/2017
PW-Misc
Informational
12/18/2017
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
12/19/2017
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
Water Line - Coliform Test 2 Failed 12/20/2017 at 9:30 AM 12/20/2017
PW-Misc
Informational
12/19/2017
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
12/19/2017
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
12/20/2017
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
Water Line - Coliform Test 2 Failed 12/22/2017 at 10:30 AM 12/22/2017
PW-Misc
Informational
12/20/2017
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
12/20/2017
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
12/20/2017
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
12/22/2017
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
Water Line - Coliform Test 2 Partial 1/2/2018 at 10:45 AM 01/02/2018
PW-Misc
Informational
12/22/2017
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
12/22/2017
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
12/22/2017
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
12/22/2017
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
01/02/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
Site Visit Partial 1/3/2018 at 9:30 AM 01/03/2018
PW-Misc
Corrective Action Required
01/03/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
Site Visit Partial 1/3/2018 at 1:45 PM 01/03/2018
PW-Misc
Corrective Action Required
01/03/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Resolved
01/03/2018
The contractor pumped the water out of the hole and put new straw in. We are planning on chlorinate on friday.Steve Robbins 01/03/2018 2:18 PM
Site Visit Partial 1/5/2018 at 7:30 AM 01/05/2018
PW-Misc
Corrective Action Required
01/03/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/05/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
Site Visit Partial 1/8/2018 at 10:30 AM 01/08/2018
PW-Misc
Corrective Action Required
01/05/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/05/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/08/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
Site Visit Partial 1/9/2018 at 11:30 AM 01/09/2018
PW-Misc
Corrective Action Required
01/08/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/08/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/08/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
PW-Misc
Corrective Action Required
01/09/2018
I talked with Scott and he said they will be getting the erosion control put back up. There was no work going on today.Steve Robbins 01/09/2018 12:55 PM
Site Visit Failed 1/10/2018 at 2:30 PM 01/10/2018
PW-Misc
Corrective Action Required
01/09/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/09/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/09/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
PW-Misc
Corrective Action Required
01/09/2018
I talked with Scott and he said they will be getting the erosion control put back up. There was no work going on today.Steve Robbins 01/09/2018 12:55 PM
PW-Misc
Corrective Action Required
01/10/2018
I talked with Scott again today and he said he was out of town the rest of the week. He said he told his boss about the erosion control and he was suppose to take care of it. I sent his boss an e-mail. After talking to the other inspectors who have been on the job this has been going on for a long time. If this is not resolved soon I will have to shut the job site down until it is resolved. Steve Robbins 01/10/2018 3:33 PM
Site Visit Failed 1/11/2018 at 10:15 AM 01/11/2018
PW-Misc
Corrective Action Required
01/10/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/10/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/10/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
PW-Misc
Corrective Action Required
01/10/2018
I talked with Scott and he said they will be getting the erosion control put back up. There was no work going on today.Steve Robbins 01/09/2018 12:55 PM
PW-Misc
Corrective Action Required
01/10/2018
I talked with Scott again today and he said he was out of town the rest of the week. He said he told his boss about the erosion control and he was suppose to take care of it. I sent his boss an e-mail. After talking to the other inspectors who have been on the job this has been going on for a long time. If this is not resolved soon I will have to shut the job site down until it is resolved. Steve Robbins 01/10/2018 3:33 PM
PW-Misc
Corrective Action Required
01/11/2018
The erosion control has still not been taken care of, I have sent and e-mail to scott and doug. Scott said to send it to doug, I have not heard back from him. I am going to e-mail him this inspection summary with hopes he will respond.Steve Robbins 01/11/2018 11:07 AM
Site Visit Failed 1/18/2018 at 7:45 AM 01/18/2018
PW-Misc
Corrective Action Required
01/11/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/11/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/11/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
PW-Misc
Corrective Action Required
01/11/2018
I talked with Scott and he said they will be getting the erosion control put back up. There was no work going on today.Steve Robbins 01/09/2018 12:55 PM
PW-Misc
Corrective Action Required
01/11/2018
I talked with Scott again today and he said he was out of town the rest of the week. He said he told his boss about the erosion control and he was suppose to take care of it. I sent his boss an e-mail. After talking to the other inspectors who have been on the job this has been going on for a long time. If this is not resolved soon I will have to shut the job site down until it is resolved. Steve Robbins 01/10/2018 3:33 PM
PW-Misc
Corrective Action Required
01/11/2018
The erosion control has still not been taken care of, I have sent and e-mail to scott and doug. Scott said to send it to doug, I have not heard back from him. I am going to e-mail him this inspection summary with hopes he will respond.Steve Robbins 01/11/2018 11:07 AM
PW-Misc
Corrective Action Required
01/18/2018
The erosion control has still not been taken care of. I spoke with Khanh about this and he said he will tell them no more inspections until the erosion is taken care of. I have also spoken with and e-mailed Doug Rothfuss about the erosion control and also spoke to Scott Fischer. Doug let me know in the e-mail that there is not a problem with erosion right now and he will get to it when he can because it is frozen. I let them know they could also use mulch.Steve Robbins 01/18/2018 8:00 AM
Water Line - Coliform Test 2 Partial 1/19/2018 at 2:00 PM 01/19/2018
PW-Misc
Informational
01/02/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
01/02/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
01/02/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
01/02/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
01/02/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
01/19/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
Site Visit Partial 1/22/2018 at 11:45 AM 01/22/2018
PW-Misc
Informational
01/22/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
Erosion Control Inspection Failed 1/23/2018 at 10:45 AM 01/23/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/23/2018
There are problems with the erosion control devices on your site. The contractor still has made no effort to get the erosion control put up, by either the silt fence or mulch. I have spoke with Khanh and he said he will give not more inspections until the erosion control has been installed.Steve Robbins 01/23/2018 11:13 AM
Erosion Control Inspection Failed 1/25/2018 at 2:45 PM 01/25/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/23/2018
There are problems with the erosion control devices on your site. The contractor still has made no effort to get the erosion control put up, by either the silt fence or mulch. I have spoke with Khanh and he said he will give not more inspections until the erosion control has been installed.Steve Robbins 01/23/2018 11:13 AM
PW-Erosion and Sediment Control
Corrective Action Required
01/25/2018
Your project is in violation of the Erosion and Sediment control policy. They still have not silt fence up.Steve Robbins 01/25/2018 3:48 PM
Pavement-Aggregate Base Passed 1/26/2018 at 1:15 PM 01/26/2018
Informational
01/26/2018
The base asphalt has been installed on this before i got it. I am passing the sub gradeSteve Robbins 01/26/2018 1:32 PM.
Erosion Control Inspection Failed 1/29/2018 at 9:30 AM 01/29/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/25/2018
There are problems with the erosion control devices on your site. The contractor still has made no effort to get the erosion control put up, by either the silt fence or mulch. I have spoke with Khanh and he said he will give not more inspections until the erosion control has been installed.Steve Robbins 01/23/2018 11:13 AM
PW-Erosion and Sediment Control
Corrective Action Required
01/25/2018
Your project is in violation of the Erosion and Sediment control policy. They still have not silt fence up.Steve Robbins 01/25/2018 3:48 PM
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/29/2018
There are problems with the erosion control devices on your site. I feel the city has been patient and willing to work with this contractor and he has not taken care of the erosion control.The contractor said the ground was frozen. The weather has been warmer for over a week now. I am sending Doug and e-mail to let him know if this issue is not taken care of by Thursday February 1, 2018 the city will be issuing a stop work order and shut down notice.Steve Robbins 01/29/2018 9:59 AM
Erosion Control Inspection Passed 1/30/2018 at 11:00 AM 01/30/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/29/2018
There are problems with the erosion control devices on your site. The contractor still has made no effort to get the erosion control put up, by either the silt fence or mulch. I have spoke with Khanh and he said he will give not more inspections until the erosion control has been installed.Steve Robbins 01/23/2018 11:13 AM
PW-Erosion and Sediment Control
Corrective Action Required
01/29/2018
Your project is in violation of the Erosion and Sediment control policy. They still have not silt fence up.Steve Robbins 01/25/2018 3:48 PM
PW-Devices for Erosion and Sediment Control
Corrective Action Required
01/29/2018
There are problems with the erosion control devices on your site. I feel the city has been patient and willing to work with this contractor and he has not taken care of the erosion control.The contractor said the ground was frozen. The weather has been warmer for over a week now. I am sending Doug and e-mail to let him know if this issue is not taken care of by Thursday February 1, 2018 the city will be issuing a stop work order and shut down notice.Steve Robbins 01/29/2018 9:59 AM
PW-Misc
Resolved
01/30/2018
The contractor has put in mulch for the erosion control on the west side of the property which is in the back of the building. Steve Robbins 01/30/2018 2:42 PM
Water Line - Coliform Test 2 Partial 1/31/2018 at 10:45 AM 01/31/2018
PW-Misc
Informational
01/19/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
01/19/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
01/19/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
01/19/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
01/19/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
01/19/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
01/31/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
Water Line - Coliform Test 2 Partial 2/2/2018 at 1:15 PM 02/02/2018
PW-Misc
Informational
01/31/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
01/31/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
01/31/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
01/31/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
01/31/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
01/31/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
01/31/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/02/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
Water Line - Coliform Test 2 Partial 2/5/2018 at 9:00 AM 02/05/2018
PW-Misc
Informational
02/02/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/02/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/02/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/02/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/02/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/02/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/02/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/02/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/05/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
Water Line - Coliform Test 2 Partial 2/6/2018 at 9:00 AM 02/06/2018
PW-Misc
Informational
02/05/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/05/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/05/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/05/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/05/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/05/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/05/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/05/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/05/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/06/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
Water Line - Coliform Test 2 Failed 2/7/2018 at 9:45 AM 02/07/2018
PW-Misc
Informational
02/06/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/06/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/06/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/06/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/06/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/06/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/06/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/06/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/06/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/06/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
PW-Misc
Informational
02/07/2018
The second sample failed. They are going to flush the water line again and the backflow preventer. We are going to flush on Monday.Steve Robbins 02/07/2018 11:03 AM
Water Line - Coliform Test 2 Partial 2/12/2018 at 8:30 AM 02/12/2018
PW-Misc
Informational
02/07/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/07/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/07/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/07/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/07/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/07/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/07/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/07/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/07/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/07/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
PW-Misc
Informational
02/07/2018
The second sample failed. They are going to flush the water line again and the backflow preventer. We are going to flush on Monday.Steve Robbins 02/07/2018 11:03 AM
PW-Misc
Corrective Action Required
02/12/2018
We were flushing the line through the fire hydrant and the backflow preventer. The fire hydrant seems to be frozen, Jeremy stayed with the contractor as he was trying to get it to flow. Jeremy called and said the contractor will come back later and check on it.Steve Robbins 02/12/2018 9:57 AM
Water Line - Coliform Test 2 Partial 2/13/2018 at 9:00 AM 02/13/2018
PW-Misc
Informational
02/12/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/12/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/12/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/12/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/12/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/12/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/12/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/12/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/12/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/12/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
PW-Misc
Informational
02/12/2018
The second sample failed. They are going to flush the water line again and the backflow preventer. We are going to flush on Monday.Steve Robbins 02/07/2018 11:03 AM
PW-Misc
Corrective Action Required
02/12/2018
We were flushing the line through the fire hydrant and the backflow preventer. The fire hydrant seems to be frozen, Jeremy stayed with the contractor as he was trying to get it to flow. Jeremy called and said the contractor will come back later and check on it.Steve Robbins 02/12/2018 9:57 AM
PW-Misc
Informational
02/13/2018
We flushed the line yesterday , I took the first sample this morning to the lab.Steve Robbins 02/13/2018 10:57 AM
Water Line - Coliform Test 2 Partial 2/14/2018 at 9:00 AM 02/14/2018
PW-Misc
Informational
02/13/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/13/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/13/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/13/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/13/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/13/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/13/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/13/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/13/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/13/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
PW-Misc
Informational
02/13/2018
The second sample failed. They are going to flush the water line again and the backflow preventer. We are going to flush on Monday.Steve Robbins 02/07/2018 11:03 AM
PW-Misc
Corrective Action Required
02/13/2018
We were flushing the line through the fire hydrant and the backflow preventer. The fire hydrant seems to be frozen, Jeremy stayed with the contractor as he was trying to get it to flow. Jeremy called and said the contractor will come back later and check on it.Steve Robbins 02/12/2018 9:57 AM
PW-Misc
Informational
02/13/2018
We flushed the line yesterday , I took the first sample this morning to the lab.Steve Robbins 02/13/2018 10:57 AM
PW-Misc
Informational
02/14/2018
Steve Robbins 02/14/2018 12:15 PMThe sample from yesterday passed, I took the second sample with Jeremy this morning.
Water Line - Coliform Test 2 Passed 2/15/2018 at 3:15 PM 02/15/2018
PW-Misc
Informational
02/14/2018
Nick told me the water sample failed on the second day when nick took them to the lab. Today we did a flush of the fire line through the back flow . We are going to take a sample in the morning from the back flow. The domestic was tapped into the fire line that came accross the street.Steve Robbins 12/18/2017 3:00 PM
PW-Misc
Informational
02/14/2018
I took samples from the backflow preventer this morning.Steve Robbins 12/19/2017 1:05 PM
PW-Misc
Corrective Action Required
02/14/2018
The first sample failed, when i got to the lab they told me that they passed so i gave them the second sample. They called back later and said they failed so i am going to see if the second sample passes because we already ran it through.Steve Robbins 12/20/2017 4:21 PM
PW-Misc
Corrective Action Required
02/14/2018
The second sample failed, we are going to chlorinate at the end of next week and start all over.Steve Robbins 12/22/2017 11:32 AM
PW-Misc
Informational
02/14/2018
We are going to chlolrinate at the end of the week.Steve Robbins 01/02/2018 10:54 AM
PW-Misc
Informational
02/14/2018
They have not re-chlorinated the water line yet. Hopefully next week.Steve Robbins 01/19/2018 3:45 PM
PW-Misc
Informational
02/14/2018
This morning we flushed the water line and then chlorinated it. We are going to de-chlorinate on friday morning and flush.Steve Robbins 01/31/2018 11:54 AM
PW-Misc
Informational
02/14/2018
This afternoon we de-chlorinated the water line and did a flush through the fire hydrant. We will take sample on monday morning from the back-flow preventer.Steve Robbins 02/02/2018 1:50 PM
PW-Misc
Informational
02/14/2018
Today I took 2 samples to blue valley lab out of the backflow preventer. I took 1 sample and 1 duplicate.Steve Robbins 02/05/2018 12:42 PM
PW-Misc
Informational
02/14/2018
The water samples from the first day have passed. I took the second round of samples to the lab this morning.Steve Robbins 02/06/2018 10:57 AM
PW-Misc
Informational
02/14/2018
The second sample failed. They are going to flush the water line again and the backflow preventer. We are going to flush on Monday.Steve Robbins 02/07/2018 11:03 AM
PW-Misc
Corrective Action Required
02/14/2018
We were flushing the line through the fire hydrant and the backflow preventer. The fire hydrant seems to be frozen, Jeremy stayed with the contractor as he was trying to get it to flow. Jeremy called and said the contractor will come back later and check on it.Steve Robbins 02/12/2018 9:57 AM
PW-Misc
Informational
02/14/2018
We flushed the line yesterday , I took the first sample this morning to the lab.Steve Robbins 02/13/2018 10:57 AM
PW-Misc
Informational
02/14/2018
Steve Robbins 02/14/2018 12:15 PMThe sample from yesterday passed, I took the second sample with Jeremy this morning.
PW-Misc
Informational
02/15/2018
Blue Valley Lab called and let me know the water samples for both day have passed. They will e-mail the results for the files. This completes all the water for this project.Steve Robbins 02/15/2018 3:23 PM
Erosion Control Inspection Failed 2/21/2018 at 9:45 AM 02/21/2018
PW-Devices for Erosion and Sediment Control
Corrective Action Required
02/21/2018
There are problems with the erosion control devices on your site. The silt fence in front of and around the building has fallen down. I called Scott Fischer and let him know that the fence needs to get back up, he saind he would take care of it. I am giving them to March 2, 2018 to get it up because the ground is frozen.Steve Robbins 02/21/2018 11:50 AM
Water Line - Coliform Test 1 Passed 2/28/2018 02/28/2018
PW-Misc
Informational
11/28/2017
Matt Munger 11/28/2017 11:58 AM Took first set of samples 2 from BFP vault and 2 from end of line.
Erosion Control Inspection Failed 3/22/2018 at 9:30 AM 03/22/2018
PW-Erosion and Sediment Control
Corrective Action Required
03/22/2018
Your project is in violation of the Erosion and Sediment control policy. The silt fence needs to be put back up.Steve Robbins 03/22/2018 1:37 PM
Erosion Control Inspection Failed 3/26/2018 03/26/2018
PW-Erosion and Sediment Control
Corrective Action Required
03/22/2018
Your project is in violation of the Erosion and Sediment control policy. The silt fence needs to be put back up.Steve Robbins 03/22/2018 1:37 PM
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/26/2018
The have not put up the silt fence yet.Steve Robbins 03/26/2018 2:40 PM
Erosion Control Inspection Failed 3/28/2018 at 9:15 AM 03/28/2018
PW-Erosion and Sediment Control
Corrective Action Required
03/26/2018
Your project is in violation of the Erosion and Sediment control policy. The silt fence needs to be put back up.Steve Robbins 03/22/2018 1:37 PM
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/26/2018
The have not put up the silt fence yet.Steve Robbins 03/26/2018 2:40 PM
PW-Erosion and Sediment Control
Corrective Action Required
03/28/2018
Your project is in violation of the Erosion and Sediment control policy. I sent Doug and e-mail for the second time letting him know of this problem, he has not responded. I will no longer do any inspections after friday and will notify the building inspector.Steve Robbins 03/28/2018 9:34 AM
Erosion Control Inspection Passed 4/2/2018 at 1:15 PM 04/02/2018
PW-Erosion and Sediment Control
Corrective Action Required
03/28/2018
Your project is in violation of the Erosion and Sediment control policy. The silt fence needs to be put back up.Steve Robbins 03/22/2018 1:37 PM
PW-Devices for Erosion and Sediment Control
Corrective Action Required
03/28/2018
The have not put up the silt fence yet.Steve Robbins 03/26/2018 2:40 PM
PW-Erosion and Sediment Control
Corrective Action Required
03/28/2018
Your project is in violation of the Erosion and Sediment control policy. I sent Doug and e-mail for the second time letting him know of this problem, he has not responded. I will no longer do any inspections after friday and will notify the building inspector.Steve Robbins 03/28/2018 9:34 AM
PW-Misc
Informational
04/02/2018
The contractor has put up the silt fence and taken care of the erosion control situation.Steve Robbins 04/02/2018 3:26 PM
Water Line - Fire Hydrant Passed 4/2/2018 04/02/2018
Sidewalk Inspection Partial 4/17/2018 at 9:30 AM 04/17/2018
PW-Install sidewalk
Informational
04/17/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
Sidewalk Inspection Partial 4/19/2018 at 8:00 AM 04/19/2018
PW-Install sidewalk
Informational
04/17/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
PW-Install sidewalk
Informational
04/19/2018
The contractors formed the sidewalk in front of the building goning along Independence. The formed the 5 ft sidewalk and compacted the rock, they stopped about 15-20ft before they got to the corner for the ADA ramp. Bob Burns came out to help with the construction talk on the ADA ramp. I gave them an inspection for the section on Independence. They poured the sidewalk for that section and will be ready for another inspection in the morning.Steve Robbins 04/19/2018 3:34 PM
Sidewalk Inspection Partial 4/24/2018 at 12:00 PM 04/24/2018
PW-Install sidewalk
Informational
04/19/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
PW-Install sidewalk
Informational
04/19/2018
The contractors formed the sidewalk in front of the building goning along Independence. The formed the 5 ft sidewalk and compacted the rock, they stopped about 15-20ft before they got to the corner for the ADA ramp. Bob Burns came out to help with the construction talk on the ADA ramp. I gave them an inspection for the section on Independence. They poured the sidewalk for that section and will be ready for another inspection in the morning.Steve Robbins 04/19/2018 3:34 PM
PW-Install sidewalk
Informational
04/24/2018
All has been formed except for the ADA ramps on the corner of independence and Jones insdustrial. The rock has been installed and compacted and sidewalk formed. They are planning on pouring on 4/24.Steve Robbins 04/24/2018 10:40 AM
Sidewalk Inspection Partial 4/30/2018 at 2:15 PM 04/30/2018
PW-Install sidewalk
Informational
04/24/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
PW-Install sidewalk
Informational
04/24/2018
The contractors formed the sidewalk in front of the building goning along Independence. The formed the 5 ft sidewalk and compacted the rock, they stopped about 15-20ft before they got to the corner for the ADA ramp. Bob Burns came out to help with the construction talk on the ADA ramp. I gave them an inspection for the section on Independence. They poured the sidewalk for that section and will be ready for another inspection in the morning.Steve Robbins 04/19/2018 3:34 PM
PW-Install sidewalk
Informational
04/24/2018
All has been formed except for the ADA ramps on the corner of independence and Jones insdustrial. The rock has been installed and compacted and sidewalk formed. They are planning on pouring on 4/24.Steve Robbins 04/24/2018 10:40 AM
PW-Install sidewalk
Partial Correction
04/30/2018
There is sidewalk on your property which must be installed. All the sidewalk has passed except for the 2 ADA ramps on Independence and 3 panels of sidewalk that have been removed and need to be replaced.Steve Robbins 04/30/2018 4:03 PM
Sidewalk Inspection Partial 5/2/2018 at 8:45 AM 05/02/2018
PW-Install sidewalk
Informational
04/30/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
PW-Install sidewalk
Informational
04/30/2018
The contractors formed the sidewalk in front of the building goning along Independence. The formed the 5 ft sidewalk and compacted the rock, they stopped about 15-20ft before they got to the corner for the ADA ramp. Bob Burns came out to help with the construction talk on the ADA ramp. I gave them an inspection for the section on Independence. They poured the sidewalk for that section and will be ready for another inspection in the morning.Steve Robbins 04/19/2018 3:34 PM
PW-Install sidewalk
Informational
04/30/2018
All has been formed except for the ADA ramps on the corner of independence and Jones insdustrial. The rock has been installed and compacted and sidewalk formed. They are planning on pouring on 4/24.Steve Robbins 04/24/2018 10:40 AM
PW-Install sidewalk
Partial Correction
04/30/2018
There is sidewalk on your property which must be installed. All the sidewalk has passed except for the 2 ADA ramps on Independence and 3 panels of sidewalk that have been removed and need to be replaced.Steve Robbins 04/30/2018 4:03 PM
PW-Install ADA for sidewalk
Informational
05/02/2018
An ADA panel is required for your sidewalk crossing. There is no one here working on the sidewalk today, it rained a little bit this morning.Steve Robbins 05/02/2018 9:06 AM
ADA Inspection Partial 5/4/2018 at 2:30 PM 05/04/2018
Informational
05/04/2018
The ADA ramps at the corner of Independence and Jones Idustrial Dr. have been formed and are ADA compliant for the pre-pour. Matt Munger and I went to the site and let them know the cannot use a 4 ft. trunkated dome for a 5 ft. sidewalk.Steve Robbins 05/04/2018 3:50 PM
ADA Inspection Partial 5/7/2018 at 7:45 AM 05/07/2018
Informational
05/07/2018
This morning they were pouring the 2 ADA ramps at the corner of Independence and Jones Industrial dr. Last Friday they were formed and rock was installed and the rock was compacted. They also had smooth dowels for the ramp.Steve Robbins 05/07/2018 2:51 PM
Sidewalk Inspection Passed 5/8/2018 at 9:40 AM 05/08/2018
PW-Install sidewalk
Informational
05/02/2018
There is sidewalk on your property which must be installed. The contractors graded out the path for the sidewalk and have started to form.Steve Robbins 04/17/2018 11:00 AM
PW-Install sidewalk
Informational
05/02/2018
The contractors formed the sidewalk in front of the building goning along Independence. The formed the 5 ft sidewalk and compacted the rock, they stopped about 15-20ft before they got to the corner for the ADA ramp. Bob Burns came out to help with the construction talk on the ADA ramp. I gave them an inspection for the section on Independence. They poured the sidewalk for that section and will be ready for another inspection in the morning.Steve Robbins 04/19/2018 3:34 PM
PW-Install sidewalk
Informational
05/02/2018
All has been formed except for the ADA ramps on the corner of independence and Jones insdustrial. The rock has been installed and compacted and sidewalk formed. They are planning on pouring on 4/24.Steve Robbins 04/24/2018 10:40 AM
PW-Install sidewalk
Partial Correction
05/02/2018
There is sidewalk on your property which must be installed. All the sidewalk has passed except for the 2 ADA ramps on Independence and 3 panels of sidewalk that have been removed and need to be replaced.Steve Robbins 04/30/2018 4:03 PM
PW-Install ADA for sidewalk
Informational
05/02/2018
An ADA panel is required for your sidewalk crossing. There is no one here working on the sidewalk today, it rained a little bit this morning.Steve Robbins 05/02/2018 9:06 AM
PW-Misc
Informational
05/08/2018
All the public sidewalk for this project has been installed and has passed inspection.Steve Robbins 05/08/2018 2:12 PM
ADA Inspection Passed 5/8/2018 at 9:50 AM 05/08/2018
Informational
05/08/2018
The 2 ADA ramps on the corner of Independence and Jones Industrial Dr. have been poured and passed inspection.Steve Robbins 05/08/2018 2:15 PM
Site Visit Partial 5/11/2018 at 9:00 AM 05/11/2018
PW-Misc
Corrective Action Required
01/18/2018
We found water by the main that still needs to be chlorinated , MODOT has a fireline leak and filled up the hole. I talked with Keith and he is going to pump out the water and cover the line with some more straw.Steve Robbins 01/03/2018 10:27 AM
PW-Misc
Informational
01/18/2018
I checked the erosion control and the silt fence in down, Nick, Matt and Troy have all asked to have the silt fence put back up and it has yet to happen. I sent Scott Ficsher and e-mail this morning asking him to get this taken care of by January 11.Steve Robbins 01/05/2018 1:34 PM
PW-Misc
Corrective Action Required
01/18/2018
I talked with Scott Fischer today about the erosion control on the property. I asked him if he could get the erosion control up on the west side of the property, he said he would talk to his boss about it.Steve Robbins 01/08/2018 11:46 AM
PW-Misc
Corrective Action Required
01/18/2018
I talked with Scott and he said they will be getting the erosion control put back up. There was no work going on today.Steve Robbins 01/09/2018 12:55 PM
PW-Misc
Corrective Action Required
01/18/2018
I talked with Scott again today and he said he was out of town the rest of the week. He said he told his boss about the erosion control and he was suppose to take care of it. I sent his boss an e-mail. After talking to the other inspectors who have been on the job this has been going on for a long time. If this is not resolved soon I will have to shut the job site down until it is resolved. Steve Robbins 01/10/2018 3:33 PM
PW-Misc
Corrective Action Required
01/18/2018
The erosion control has still not been taken care of, I have sent and e-mail to scott and doug. Scott said to send it to doug, I have not heard back from him. I am going to e-mail him this inspection summary with hopes he will respond.Steve Robbins 01/11/2018 11:07 AM
PW-Misc
Corrective Action Required
01/18/2018
The erosion control has still not been taken care of. I spoke with Khanh about this and he said he will tell them no more inspections until the erosion is taken care of. I have also spoken with and e-mailed Doug Rothfuss about the erosion control and also spoke to Scott Fischer. Doug let me know in the e-mail that there is not a problem with erosion right now and he will get to it when he can because it is frozen. I let them know they could also use mulch.Steve Robbins 01/18/2018 8:00 AM
Corrective Action Required
05/11/2018
No work going on here today.
Site Visit Partial 5/30/2018 at 8:45 AM 05/30/2018
PW-Misc
Informational
05/11/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
05/30/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
Street - Surface Course Partial 5/31/2018 at 1:45 PM 05/31/2018
PW-Misc
Corrective Action Required
05/31/2018
They have not installed the surface asphalt yet. The last couple of days they have been doing landscaping.Steve Robbins 05/31/2018 2:08 PM
Site Visit Partial 6/7/2018 at 3:00 PM 06/07/2018
PW-Misc
Informational
05/30/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
05/30/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
PW-Misc
Informational
06/07/2018
It appears that all the sod, plants, and trees and been put in. I called Jason from the PW dept. about getting the stop and street signs put back in. The biggest thing left to do is the surface asphalt in the parking lot.Steve Robbins 06/07/2018 3:31 PM
Site Visit Partial 6/12/2018 at 12:15 PM 06/12/2018
PW-Misc
Informational
06/07/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
06/07/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
PW-Misc
Informational
06/07/2018
It appears that all the sod, plants, and trees and been put in. I called Jason from the PW dept. about getting the stop and street signs put back in. The biggest thing left to do is the surface asphalt in the parking lot.Steve Robbins 06/07/2018 3:31 PM
PW-Misc
Informational
06/12/2018
Brice Lawson 06/12/2018 5:23 PM There did not appear to be any activity for this permit.
Site Visit Partial 6/21/2018 at 8:45 AM 06/21/2018
PW-Misc
Informational
06/12/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
06/12/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
PW-Misc
Informational
06/12/2018
It appears that all the sod, plants, and trees and been put in. I called Jason from the PW dept. about getting the stop and street signs put back in. The biggest thing left to do is the surface asphalt in the parking lot.Steve Robbins 06/07/2018 3:31 PM
PW-Misc
Informational
06/12/2018
Brice Lawson 06/12/2018 5:23 PM There did not appear to be any activity for this permit.
PW-Misc
Informational
06/21/2018
There is no work being done on this site today.Steve Robbins 06/21/2018 3:27 PM
ESC - (Vegetation/Ground Cover) Partial 6/21/2018 at 9:15 AM 06/21/2018
PW-Misc
Informational
06/21/2018
The contractors have installed sod all around the building and in the ROW to the east and the north of the building. They still need to vegetate behind the building to the west.Steve Robbins 06/21/2018 3:33 PM
Site Visit Partial 7/5/2018 at 7:40 AM 07/05/2018
PW-Misc
Informational
06/21/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
06/21/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
PW-Misc
Informational
06/21/2018
It appears that all the sod, plants, and trees and been put in. I called Jason from the PW dept. about getting the stop and street signs put back in. The biggest thing left to do is the surface asphalt in the parking lot.Steve Robbins 06/07/2018 3:31 PM
PW-Misc
Informational
06/21/2018
Brice Lawson 06/12/2018 5:23 PM There did not appear to be any activity for this permit.
PW-Misc
Informational
06/21/2018
There is no work being done on this site today.Steve Robbins 06/21/2018 3:27 PM
PW-Misc
Informational
07/05/2018
There is no work going on here, there will be nothing to look at until they put down the surface for the parking lot.Steve Robbins 07/05/2018 10:05 AM
Street - Surface Course Passed 8/15/2018 at 11:30 AM 08/23/2018
PW-Misc
Corrective Action Required
05/31/2018
They have not installed the surface asphalt yet. The last couple of days they have been doing landscaping.Steve Robbins 05/31/2018 2:08 PM
PW-Misc
Informational
08/23/2018
The surface has been laid on this private parking lot and everything appears to be done correctly. Hanrahan Asphalt Paving did the work for this project.Steve Robbins 08/23/2018 2:56 PM
Site Visit Complete 8/30/2018 at 1:45 PM 08/30/2018
PW-Misc
Informational
07/05/2018
Jeremy Young 01/22/2018 11:45 AM No work being done outside because of weather.
PW-Misc
Informational
07/05/2018
For the past few days they have been planting shrubbs and trees.Steve Robbins 05/30/2018 12:22 PM
PW-Misc
Informational
07/05/2018
It appears that all the sod, plants, and trees and been put in. I called Jason from the PW dept. about getting the stop and street signs put back in. The biggest thing left to do is the surface asphalt in the parking lot.Steve Robbins 06/07/2018 3:31 PM
PW-Misc
Informational
07/05/2018
Brice Lawson 06/12/2018 5:23 PM There did not appear to be any activity for this permit.
PW-Misc
Informational
07/05/2018
There is no work being done on this site today.Steve Robbins 06/21/2018 3:27 PM
PW-Misc
Informational
07/05/2018
There is no work going on here, there will be nothing to look at until they put down the surface for the parking lot.Steve Robbins 07/05/2018 10:05 AM
Corrective Action Required
08/30/2018
I did a site visit to check on everything. I will have a few punch list items but will be fine for a substantial completion.Steve Robbins 08/30/2018 2:54 PM
Backflow Preventer and Vault Passed 9/5/2018 09/05/2018
Fire Line Construction Inspection Passed 09/05/2018
Grading/Excavation/Fill Inspection Passed 09/05/2018
Pavement-Surface Passed 09/05/2018
Install Street and Stop Signs Passed 09/05/2018
Storm - Pipe Passed 09/05/2018
Storm - Inlets Clean Passed 09/05/2018
Storm - Swales Passed 09/05/2018
Storm - Outlet Structure Passed 09/05/2018
Site Visit Complete 09/05/2018
ESC - (Vegetation/Ground Cover) Partial 10/29/2018 at 7:05 AM 10/29/2018
PW-Misc
Informational
06/21/2018
The contractors have installed sod all around the building and in the ROW to the east and the north of the building. They still need to vegetate behind the building to the west.Steve Robbins 06/21/2018 3:33 PM
Misc
Informational
10/29/2018
The vegetation has not been extablished yet.Steve Robbins 10/29/2018 7:36 AM
ESC - (Vegetation/Ground Cover) Passed 12/4/2019 12/04/2019
PW-Misc
Informational
10/29/2018
The contractors have installed sod all around the building and in the ROW to the east and the north of the building. They still need to vegetate behind the building to the west.Steve Robbins 06/21/2018 3:33 PM
Misc
Informational
10/29/2018
The vegetation has not been extablished yet.Steve Robbins 10/29/2018 7:36 AM
Documents & Images
Date Uploaded File Type Document Name
05/11/2017 Receipt Receipt for transaction: 2017-002280
05/19/2017 Letter PW-Permit
09/27/2017 Letter DE-Daily Inspection Summary
09/28/2017 Letter DE-Daily Inspection Summary
09/28/2017 Letter DE-Daily Inspection Summary
09/29/2017 Letter DE-Daily Inspection Summary
09/29/2017 Letter DE-Daily Inspection Summary
09/29/2017 Letter DE-Daily Inspection Summary
10/03/2017 Letter DE-Daily Inspection Summary
10/03/2017 Letter DE-Daily Inspection Summary
10/05/2017 Letter DE-Daily Inspection Summary
10/06/2017 LBP Concrete Ticket
10/06/2017 Letter DE-Daily Inspection Summary
10/10/2017 Letter DE-Daily Inspection Summary
10/11/2017 Letter DE-Daily Inspection Summary
10/12/2017 Letter DE-Daily Inspection Summary
10/13/2017 Letter DE-Daily Inspection Summary
10/16/2017 Letter DE-Daily Inspection Summary
10/16/2017 Letter DE-Daily Inspection Summary
10/18/2017 Letter DE-Daily Inspection Summary
10/19/2017 Letter DE-Daily Inspection Summary
10/19/2017 Letter DE-Daily Inspection Summary
10/20/2017 Letter DE-Daily Inspection Summary
10/24/2017 Letter DE-Daily Inspection Summary
10/24/2017 Letter DE-Daily Inspection Summary
10/26/2017 Letter DE-Project Inspection Summary
10/26/2017 Letter DE-Daily Inspection Summary
10/26/2017 Letter DE-Daily Inspection Summary
10/27/2017 Letter DE-Daily Inspection Summary
10/30/2017 Letter DE-Daily Inspection Summary
10/31/2017 Letter DE-Daily Inspection Summary
11/01/2017 Letter DE-Daily Inspection Summary
11/03/2017 Letter DE-Daily Inspection Summary
11/06/2017 Letter DE-Daily Inspection Summary
11/08/2017 Letter DE-Daily Inspection Summary
11/08/2017 Letter DE-Daily Inspection Summary
11/10/2017 IMG_1424
11/13/2017 Letter DE-Daily Inspection Summary
11/13/2017 Letter DE-Daily Inspection Summary
11/14/2017 Letter DE-Daily Inspection Summary
11/15/2017 Letter DE-Daily Inspection Summary
11/15/2017 Letter DE-Daily Inspection Summary
11/16/2017 Letter DE-Daily Inspection Summary
11/20/2017 Letter DE-Daily Inspection Summary
11/22/2017 Letter DE-Daily Inspection Summary
11/27/2017 Letter DE-Daily Inspection Summary
11/28/2017 Letter DE-Daily Inspection Summary
11/29/2017 Letter DE-Daily Inspection Summary
12/04/2017 Letter DE-Daily Inspection Summary
12/05/2017 Letter DE-Daily Inspection Summary
12/06/2017 NW Approach Concrete Ticket
12/11/2017 Letter DE-Daily Inspection Summary
12/12/2017 Letter DE-Daily Inspection Summary
12/18/2017 Letter DE-Daily Inspection Summary
12/19/2017 Letter DE-Daily Inspection Summary
12/20/2017 Letter DE-Daily Inspection Summary
12/22/2017 Letter DE-Daily Inspection Summary
01/02/2018 Letter DE-Daily Inspection Summary
01/03/2018 Letter DE-Daily Inspection Summary
01/03/2018 Letter DE-Daily Inspection Summary
01/05/2018 Letter DE-Daily Inspection Summary
01/08/2018 Letter DE-Daily Inspection Summary
01/09/2018 Letter DE-Daily Inspection Summary
01/10/2018 Letter DE-Daily Inspection Summary
01/11/2018 Letter DE-Daily Inspection Summary
01/18/2018 Letter DE-Daily Inspection Summary
01/19/2018 Letter DE-Daily Inspection Summary
01/22/2018 Letter DE-Daily Inspection Summary
01/23/2018 Letter DE-Daily Inspection Summary
01/25/2018 Letter DE-Daily Inspection Summary
01/26/2018 Letter DE-Daily Inspection Summary
01/29/2018 Letter DE-Daily Inspection Summary
01/30/2018 Letter DE-Daily Inspection Summary
01/31/2018 Letter DE-Daily Inspection Summary
02/02/2018 Letter DE-Daily Inspection Summary
02/05/2018 Letter DE-Daily Inspection Summary
02/06/2018 Letter DE-Daily Inspection Summary
02/07/2018 Letter DE-Daily Inspection Summary
02/12/2018 Letter DE-Daily Inspection Summary
02/13/2018 Letter DE-Daily Inspection Summary
02/14/2018 Letter DE-Daily Inspection Summary
02/15/2018 Letter DE-Daily Inspection Summary
02/21/2018 Letter DE-Daily Inspection Summary
03/22/2018 Letter DE-Daily Inspection Summary
03/26/2018 Letter DE-Daily Inspection Summary
03/28/2018 Letter DE-Daily Inspection Summary
04/02/2018 Letter DE-Daily Inspection Summary
04/17/2018 Letter DE-Daily Inspection Summary
04/19/2018 Letter DE-Daily Inspection Summary
04/24/2018 Letter DE-Daily Inspection Summary
04/30/2018 Letter DE-Daily Inspection Summary
05/02/2018 Letter DE-Daily Inspection Summary
05/04/2018 Letter DE-Daily Inspection Summary
05/07/2018 Letter DE-Daily Inspection Summary
05/08/2018 Letter DE-Daily Inspection Summary
05/08/2018 Letter DE-Daily Inspection Summary
05/30/2018 Letter DE-Daily Inspection Summary
05/31/2018 Letter DE-Daily Inspection Summary
06/07/2018 Letter DE-Daily Inspection Summary
06/12/2018 Letter DE-Daily Inspection Summary
06/21/2018 Letter DE-Daily Inspection Summary
06/21/2018 Letter DE-Daily Inspection Summary
07/05/2018 Letter DE-Daily Inspection Summary
08/23/2018 Letter DE-Daily Inspection Summary
08/30/2018 Letter DE-Daily Inspection Summary
09/05/2018 Letter DE-Punch List
09/05/2018 Letter DE-Certificate of Substantial Completion Multiple Lot
09/05/2018 Letter DE-Certificate of Substantial Completion Multiple Lot
09/06/2018 LBP-V-A-2017
10/29/2018 Letter DE-Daily Inspection Summary
10/29/2018 Letter DE-Daily Inspection Summary
02/04/2020 Letter DE-Certificate of Final Acceptance (Commercial)
02/04/2020 LBP V-A 2017 Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
