Permit Application Status

PRRES20252904


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRRES20252904
Building Permit - Residential
Issued
WOODLAND OAKS LLC
NEW SINGLE FAMILY
NEW HOUSE. FINISHED/UNFINISHED BASEMENT. COVERED PATIO.
07/08/2025
08/12/2025
01/26/2026
Locations
Contacts
JW Thomas LLC, Address:14704 S Hutt rd
WOODLAND OAKS LLC, Address:656 BAYBERRY LN STE 101
Jeffrey Boehm, Address:14704 S Hutt rd, Phone:(816) 588-3193
COMFORT SYSTEMS HTG/CLG, Address:128 W Markey Rd, Phone:(816) 322-1013
ARROW CIRCLE ELECTRIC, Address:1224 SE CENTURY DR, Phone:(816) 373-4888
CENTURY PLUMBING, Address:14001 CENTURY LN, Phone:(816) 765-6066
jeff@jw-thomas.com
Reviews

There are no reviews for this permit application.

Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Development Fee $2,398.00 $2,398.00 Paid 08/12/2025
Right of Way Permit Fee $85.00 $85.00 Paid 08/12/2025
Residential Excise Tax Fee $1,022.72 $1,022.72 Paid 08/12/2025
Valuation Fee New Single Family $2,163.17 $2,163.17 Paid 08/12/2025
Parks Impact Fee Residential Zone 2 $250.00 $250.00 Paid 08/12/2025
Outstanding Fees Amount Paid Owing Date Paid
Not Ready Inspection Fee $75.00 $0.00 $75.00 Not Paid


$75.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Plot Plan Inspection Pending
Water Service Inspection - R Pending
Occupancy Inspection - Codes Residential Pending
Erosion Control Inspection Residential Pending
Misc
Corrective Action Required
12/10/2025
Erosion control is in compliance
Sewer Service Inspection - R Pending 1/29/2026
Underground Plumbing Inspection - Residential Pending 2/12/2026
Footing Inspection - Residential Passed 09/15/2025
Informational
09/15/2025
Engineer approved the footing
Erosion Control Inspection Residential Partial 9/15/2025 09/15/2025
Misc
Corrective Action Required
09/15/2025
Erosion control is in compliance
Underslab Plumbing Inspection - Residential Failed 9/15/2025 09/15/2025
Misc
Corrective Action Required
09/15/2025
The shower drain connection to the wet-vented drain shall not be below the shower trap weir. P3105.2
Underslab Plumbing Inspection - Residential Passed 9/17/2025 9/17/2025 09/17/2025
Misc
Resolved
09/17/2025
The shower drain connection to the wet-vented drain shall not be below the shower trap weir. P3105.2
Sewer Service Inspection - R Passed 10/23/2025 10/23/2025
Driveway Inspection Partial 11/4/2025 11/4/2025 11/04/2025
Misc
Informational
11/04/2025
11-4-25 NS Site visited and it appears that driveway meets city standards. Passed
Sidewalk Inspection Partial 11/6/2025 11/6/2025 11/06/2025
Misc
Informational
11/06/2025
11-6-25 NS Site visited for a pre-pour inspection and the storm boxes need expansion joints around storm box and to please connect the sidewalk to existing sidewalk. But can go ahead with pouring the sidewalk.
Sidewalk Inspection Partial 11/6/2025 11/06/2025
Misc
Informational
11/06/2025
11-6-25 NS Site visited for a pre-pour inspection and the storm boxes need expansion joints around storm box and the sidewalk needs to connect to exciting sidewalk.
Driveway Inspection Passed 11/18/2025 11/24/2025
Misc
Informational
11/04/2025
11-4-25 NS Site visited and it appears that driveway meets city standards. Passed 11-24-25 NS Site visited for after pour and it appears that driveway meets city standards and ADA Passed one panel was at 2.1
Sidewalk Inspection Passed 11/24/2025
Misc
Informational
11/06/2025
11-6-25 NS Site visited for a pre-pour inspection and the storm boxes need expansion joints around storm box and the sidewalk needs to connect to exciting sidewalk. 11-24-25 NS Site visited and it appears that sidewalk meets city standards and ADA Passed
Electrical Service Inspection Passed 12/10/2025 12/10/2025 12/10/2025
Gas Service Inspection - Residential Passed 12/10/2025 12/10/2025 12/10/2025
All Rough Inspection - Residential Failed 12/10/2025 12/10/2025 12/10/2025
Misc
Corrective Action Required
12/10/2025
-Nail garage PFH wall sheathing to the LVL w/8d@3” oc grid pattern (nail just the section above the portal wall) -Double 2x10 joists above pantry/mud area per plan -Protect water lines at kitchen wall plates where within 1.25” of surface with BOCA nail plates -Remove insulation from floor joist rim throughout -Toe nail all joists to top plates and sill plates w/ 4-8d or 3-10d -Provide 9.25” LVL beam above dining sliding door per plan -Do not secure csst gas line within 2x6 wall space -Fb patio fireplace space from roof space -Secure wiring within 8” of patio TV receptacle box -Nail hanger outside half bathroom -Provide min 12” of horizontal clearance of luminaire from storage space inside bedroom 3 closet -Provide strap at laundry exterior wall top plates bored more than 50% -Provide stud shoes at laundry and master bathroom exterior wall studs bored more than 40% -Fb dead spaces and fireplace space in master bedroom from roof -Support roof framing above master bathroom per code. Support hips and valley at ridge -Fb stair wall from stair landing joist space; fb all basement wall space from joist space -Complete framing at basement bathroom shower and fb as required -Protect wiring running across bottom of joists with running board per code -Protect SE cable with overcurrent device at the point of connection to power, or the feeder tap must meet requirements of NEC 240.21(B) **DO NO INSULATE
Erosion Control Inspection Residential Partial 12/10/2025 12/10/2025
Misc
Corrective Action Required
09/15/2025
Erosion control is in compliance
All Rough Inspection - Residential Failed 12/17/2025 12/17/2025 12/17/2025
Misc
Corrective Action Required
12/10/2025

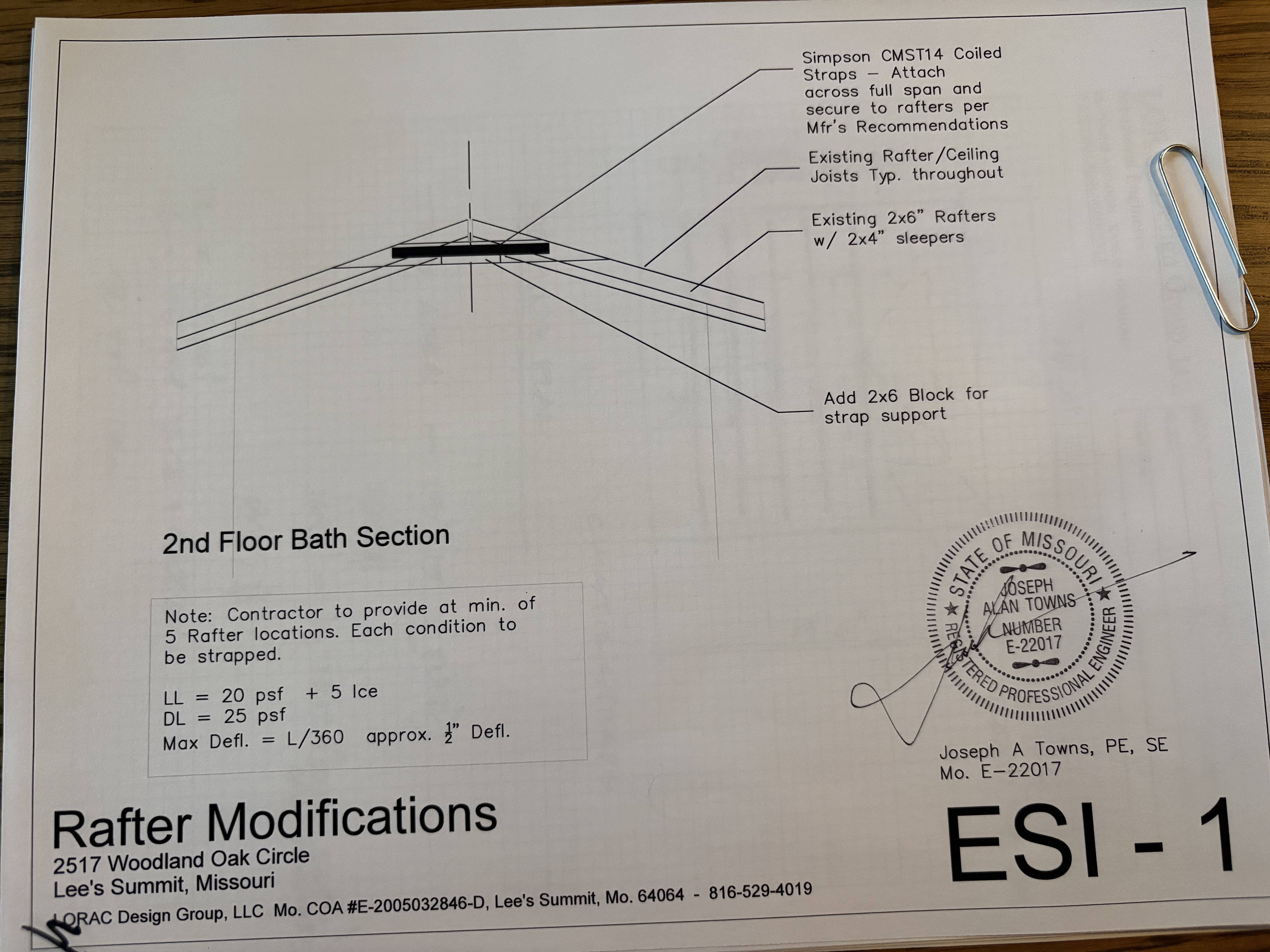

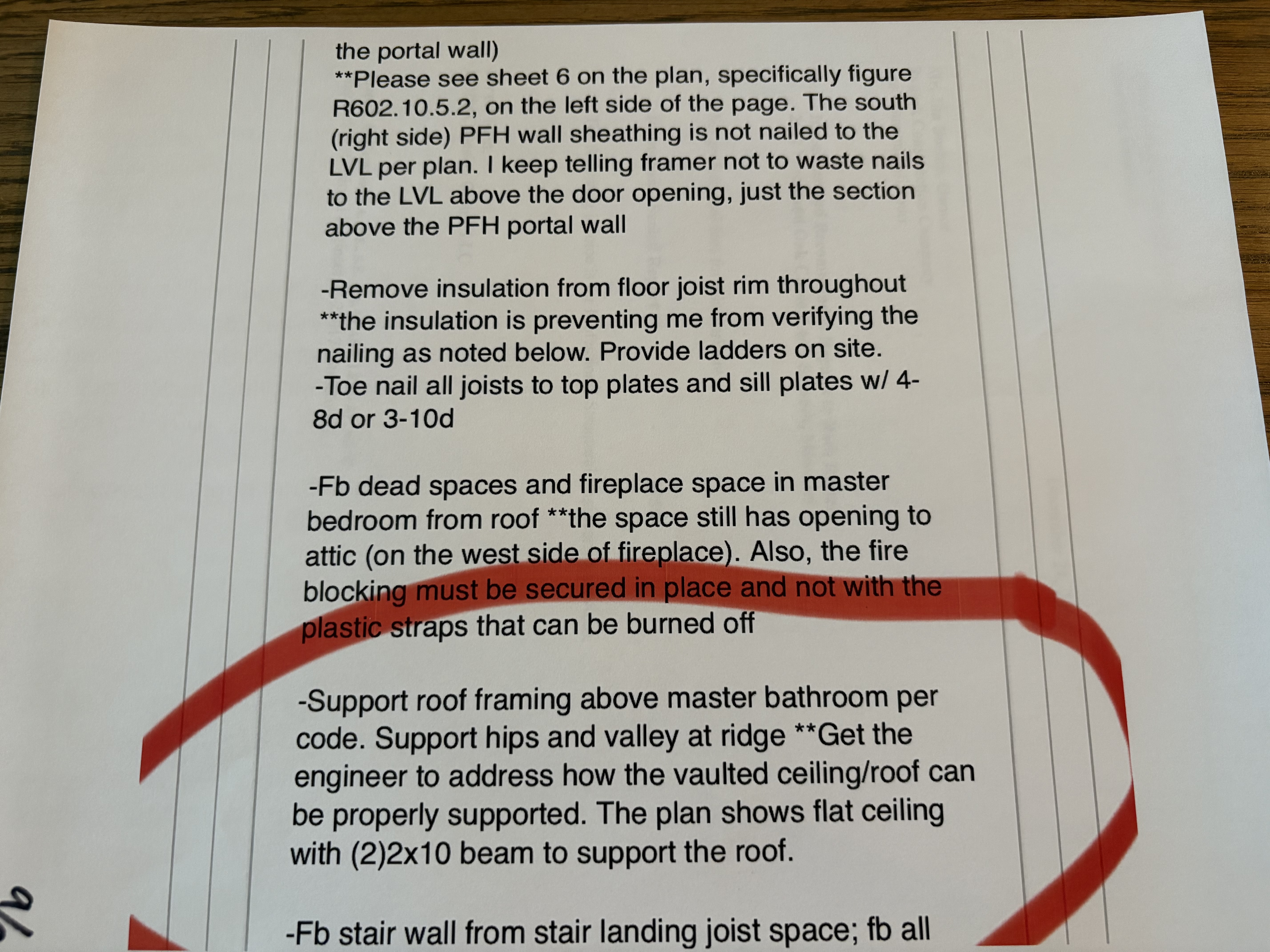

-Nail garage PFH wall sheathing to the LVL w/8d@3” oc grid pattern (nail just the section above the portal wall) **Please see sheet 6 on the plan, specifically figure R602.10.5.2, on the left side of the page. The south (right side) PFH wall sheathing is not nailed to the LVL per plan. I keep telling framer not to waste nails to the LVL above the door opening, just the section above the PFH portal wall -Remove insulation from floor joist rim throughout **the insulation is preventing me from verifying the nailing as noted below. Provide ladders on site. -Toe nail all joists to top plates and sill plates w/ 4-8d or 3-10d -Fb dead spaces and fireplace space in master bedroom from roof **the space still has opening to attic (on the west side of fireplace). Also, the fire blocking must be secured in place and not with the plastic straps that can be burned off -Support roof framing above master bathroom per code. Support hips and valley at ridge **Get the engineer to address how the vaulted ceiling/roof can be properly supported. The plan shows flat ceiling with (2)2x10 beam to support the roof. -Fb stair wall from stair landing joist space; fb all basement wall space from joist space **DO NO INSULATE
All Rough Inspection - Residential Not Ready 12/30/2025 12/30/2025 12/30/2025
Misc
Corrective Action Required
12/17/2025
-Nail garage PFH wall sheathing to the LVL w/8d@3” oc grid pattern (nail just the section above the portal wall) **Please see sheet 6 on the plan, specifically figure R602.10.5.2, on the left side of the page. The south (right side) PFH wall sheathing is not nailed to the LVL per plan. I keep telling framer not to waste nails to the LVL above the door opening, just the section above the PFH portal wall -Fb stair wall from stair landing joist space **OK TO INSULATE **12/30-Not ready fee assessed. This is a 3rd failed inspection. Each subsequent failed inspection will incur additional fee
All Rough Inspection - Residential Passed 12/31/2025 12/31/2025 12/31/2025
Misc
Resolved
12/31/2025
-Nail garage PFH wall sheathing to the LVL w/8d@3” oc grid pattern (nail just the section above the portal wall) **Please see sheet 6 on the plan, specifically figure R602.10.5.2, on the left side of the page. The south (right side) PFH wall sheathing is not nailed to the LVL per plan. I keep telling framer not to waste nails to the LVL above the door opening, just the section above the PFH portal wall -Fb stair wall from stair landing joist space **OK TO INSULATE **12/30-Not ready fee assessed. This is a 3rd failed inspection. Each subsequent failed inspection will incur additional fee
Documents & Images
Date Uploaded File Type Document Name
07/08/2025 Lot 21 Woodland oaks plot plan
07/08/2025 Residental Permit Application lot 21
07/08/2025 License_Tax_Application lot 21
07/11/2025 Permit Codes Residential Plan Review
07/16/2025 Approved Plans APPROVED PLANS
07/30/2025 Permit Codes Residential Plan Review
08/01/2025 Plot Plan APPROVED PLOT PLAN
08/01/2025 Permit Codes Residential Plan Review
08/12/2025 Permit DS Building Permit
08/12/2025 Receipt Receipt for transaction: 2025-006322
08/29/2025 M L Crose 2517 NW Woodland Oaks Dr LSMO 3rd Party Subgrade Inspection Report Pg 1 of 2 8-27-25
08/29/2025 M L Crose 2517 NW Woodland Oaks Dr LSMO 3rd Party Subgrade Inspection Report Pg 2 of 2 8-27-25
09/15/2025 Letter INSPECTION SUMMARY
09/15/2025 Letter INSPECTION SUMMARY
09/15/2025 Letter INSPECTION SUMMARY
09/17/2025 Letter INSPECTION SUMMARY
10/23/2025 Letter INSPECTION SUMMARY
11/04/2025 Letter INSPECTION SUMMARY
11/06/2025 Letter INSPECTION SUMMARY
11/06/2025 Letter INSPECTION SUMMARY
11/24/2025 Letter INSPECTION SUMMARY
11/24/2025 Letter INSPECTION SUMMARY
12/10/2025 Letter INSPECTION SUMMARY
12/10/2025 Letter INSPECTION SUMMARY
12/10/2025 Letter INSPECTION SUMMARY
12/10/2025 Letter INSPECTION SUMMARY
12/17/2025 Letter INSPECTION SUMMARY
12/24/2025 Engineer report 1 lot 21
12/24/2025 Engineering report 2 lot 21
12/24/2025 Engineer Report/Study Engineer report 1 lot 21
12/30/2025 Letter INSPECTION SUMMARY
12/31/2025 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
