Summary
PRCOM20225302
Building Permit - Commercial
Certificate of Occupancy
REORGANIZED SCHOOL DIST NO 7
NEW COMMERCIAL
NEW 7,100 SQUARE FOOT ROBOTICS FACILITY
10/21/2022
12/06/2022
05/03/2023
01/26/2024
Locations
Contacts
REORGANIZED SCHOOL DIST NO 7, Address:301 NE Tudor Rd
MULTISTUDIO, Address:4200 PENNSYLVANIA AVE
Newkirk Novak Construction Partners, Inc., Address:15345 W 87TH ST PKWY, Phone:(913) 312-9535
Arrowhead Electric Inc, Address:1101 W Main St Suite B, Phone:(816) 656-0555
EDWARDS MCDOWELL INC, Address:400 E 10TH AVE, Phone:(816) 221-7878
QUESTEC MECHANICAL INC, Address:1390 E BOONE INDUSTRIAL DR, SUITE 260, Phone:(573) 875-0260
Spencer Brown, Phone:(913) 312-9541
Reviews
Review Type Outcome Est. Completion Date Completed
Alarm Plan Review Released for Construction 11/04/2022 05/31/2023
Jim Eden
Construction documents for fire alarm systems
Corrective Action Required
05/31/2023

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Received
Installation acceptance testing
Corrective Action Required
05/31/2023

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Call (816) 969-1300 to schedule a test.
Building Plan Review Approved 11/21/2022 12/02/2022
Joe Frogge
Final Development Plan
Resolved
12/02/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational. 11/15/22 - acknowledged in letter
IBC 1803.1 General - geotech
Resolved
11/15/2022

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf. (3,000 specified on sheet S001)
Planning - Screening of rooftop equipment
Resolved
11/15/2022

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: Parapets are required to be at least as tall as equipment being screened. 11/15/22 - screening adequate per arch
IMC 306.5 Equipment on roofs
Resolved
11/15/2022

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide ladder side rail extender to comply. Re: detail A5 on A322.
IMC 403.2.1 Recirculation of air
Resolved
11/15/2022

2018 IMC 403.2.1 Recirculation of air, item #3. Where mechanical exhaust is required by Note b in Table 403.3.1.1, recirculation of air from such spaces shall be prohibited. Recirculation of air that is contained completely within such spaces shall not be prohibited. Where recirculation of air is prohibited, all air supplied to such spaces shall be exhausted, including any air in excess of that required by Table 403.3.1.1. Action required: Exhaust air from restrooms is not to be recirculated but control point RD-CO appears to allow such a thing. Redesign or clarify to demonstrate compliance. 11/15/22 - rtu is 100% outside air
Final Development Plan Review Approved 12/09/2022 12/02/2022
Mike Weisenborn
Licensed Contractors Approved 11/21/2022 11/23/2022
Joe Frogge
LC - General Contractor
Resolved
11/15/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Resolved
11/23/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors. 11/15/22 - arrowhead electric not currently licensed with us.
Fire Plan Review Approved with Conditions 11/21/2022 11/16/2022
Ben Hicks
Installation acceptance testing
Corrective Action Required
11/14/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test. Action Required: All acceptance testing of alarms will be through Lee's Summit Fire Dept. prior to final inpection. Contact 816-969-1300 to schedule testing.
Construction documents for fire alarm systems
Corrective Action Required
11/14/2022

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions. Action Required: Acknowledged in letter deferred submittal.
Illumination required
Resolved
11/16/2022

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied.
Fire Plan Review Rejected 11/04/2022 11/02/2022
Ben Hicks
Installation acceptance testing
Corrective Action Required
11/02/2022

2018 IFC 901.5- Installation acceptance testing. Fire detection and alarm systems, fire-extinguishing systems, fire hydrant systems, fire standpipe systems, fire pump systems, private fire service mains and all other fire protection systems and appurtenances thereto shall be subject to acceptance tests as contained in the installation standards and as approved by the fire code official. The fire code official shall be notified before any required acceptance testing. The fire code official shall be notified 48 hours before any required acceptance test.
Construction documents for fire alarm systems
Corrective Action Required
11/02/2022

2018 IFC 907.1.1- Construction documents. Construction documents for fire alarm systems shall be submitted for review and approval prior to system installation. Construction documents shall include, but not be limited to, all of the following: 1. .A floor plan which indicates the use of all rooms. 2. Locations of alarm-initiating and notification appliances. 3. Alarm control and trouble signaling equipment. 4. Annunciation. 5. Power connection. 6. Battery calculations. 7. Conductor type and sizes. 8. Voltage drop calculations. 9. Manufacturers, model numbers and listing information for equipment, devices and materials. 10. Details of ceiling height and construction. 11. The interface of fire safety control functions.
Illumination required
Corrective Action Required
11/02/2022

2018 IFC 1008.1 Illumination required. The means of egress, shall be illuminated at all times the building space served by the means of egress is occupied.
Building Plan Review Rejected 11/04/2022 10/26/2022
Joe Frogge
Final Development Plan
Corrective Action Required
10/26/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is informational.
IBC 1803.1 General - geotech
Corrective Action Required
10/26/2022

2018 IBC 1803.1 General. Geotechnical investigations shall be conducted in accordance with Section 1803.2 and reported in accordance with Section 1803.6. Where required by the building official or where geotechnical investigations involve in-situ testing, laboratory testing or engineering calculations, such investigations shall be conducted by a registered design professional. Action required: Provide soils report to justify design assumption of soil bearing capacity greater than 2,000psf. (3,000 specified on sheet S001)
Planning - Screening of rooftop equipment
Corrective Action Required
10/26/2022

Unified Development Ordinance Article 8, Section 8.180.E Roof mounted equipment – All roof-mounted equipment shall be screened entirely from view by using parapet walls at the same height as the mechanical units. For additions to existing buildings that do not meet this standard, individual screens will be permitted, with the design subject to approval by the Director. Action required: Parapets are required to be at least as tall as equipment being screened.
IMC 306.5 Equipment on roofs
Corrective Action Required
10/26/2022

2018 IMC 306.5 Equipment and appliances on roofs or elevated structures. Where equipment requiring access or appliances are located on an elevated structure or the roof of a building such that personnel will have to climb higher than 16 feet above grade to access such equipment or appliances, an interior or exterior means of access shall be provided. Such access shall not require climbing over obstructions greater than 30 inches in height or walking on roofs having a slope greater than 4 units vertical in 12 units horizontal. Such access shall not require the use of portable ladders. Where access involves climbing over parapet walls, the height shall be measured to the top of the parapet wall. Permanent ladders installed to provide the required access shall comply with the following minimum design criteria: 1. The side railing shall extend above the parapet or roof edge not less than 30" (see code section for additional construction requirements) Action required: Provide ladder side rail extender to comply. Re: detail A5 on A322.
IMC 403.2.1 Recirculation of air
Corrective Action Required
10/26/2022

2018 IMC 403.2.1 Recirculation of air, item #3. Where mechanical exhaust is required by Note b in Table 403.3.1.1, recirculation of air from such spaces shall be prohibited. Recirculation of air that is contained completely within such spaces shall not be prohibited. Where recirculation of air is prohibited, all air supplied to such spaces shall be exhausted, including any air in excess of that required by Table 403.3.1.1. Action required: Exhaust air from restrooms is not to be recirculated but control point RD-CO appears to allow such a thing. Redesign or clarify to demonstrate compliance.
Licensed Contractors Rejected 11/04/2022 10/26/2022
Joe Frogge
LC - General Contractor
Corrective Action Required
10/26/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Either a Class A or Class B license is required. Provide the company name of the licensed general contractor and an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Corrective Action Required
10/26/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Commercial $12,000.00 $12,000.00 Paid 12/06/2022
$11,368.50
7232302-Commercial License Tax Fee $5,684.25 $5,684.25 Paid 10/24/2022
$5,684.25
8331401-Water Tap Fee $12,435.00 $12,435.00 Paid 12/06/2022
8350015-Water Meter Fee $3,354.14 $3,354.14 Paid 12/06/2022
8331507-Sanitary Sewer Development Fee $4,615.00 $4,615.00 Paid 12/06/2022
9110068-Storm Fee $364.50 $364.50 Paid 12/06/2022
9110071-Site Grading Fee $774.90 $774.90 Paid 12/06/2022
9110081-Paved Surface Inspection Fee $4,705.61 $4,705.61 Paid 12/06/2022
91100C8-Sanitary Sewer Insp Fees $659.40 $659.40 Paid 12/06/2022
91100C9-Water Insp Fee $360.00 $360.00 Paid 12/06/2022
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 08/21/2023
9110078-Temporary Occupancy Fee $50.00 $50.00 Paid 09/20/2023
Outstanding Fees Amount Paid Owing Date Paid

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sewer Service Inspection Partial 12/20/2022
Misc
Informational
12/20/2022

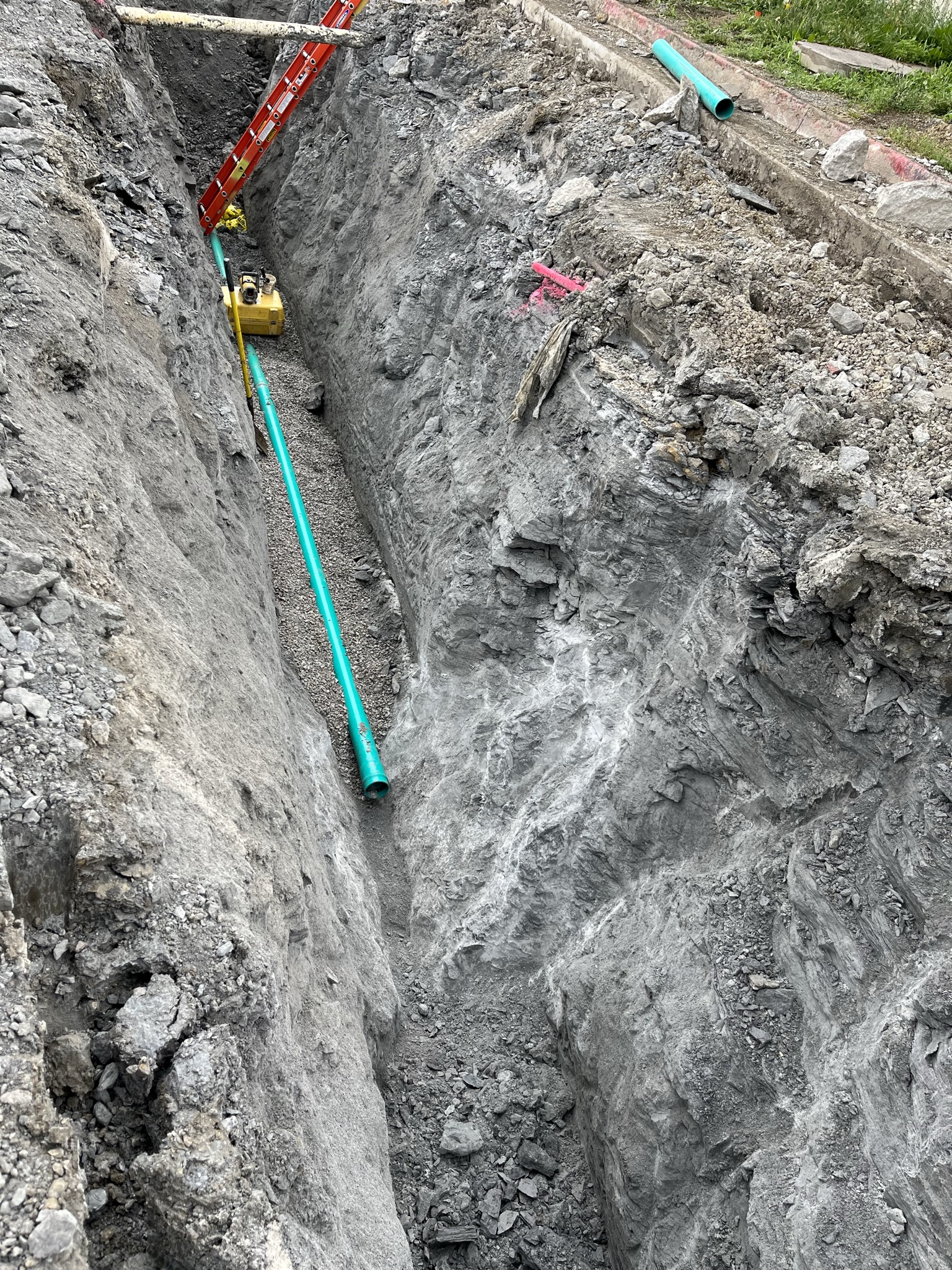

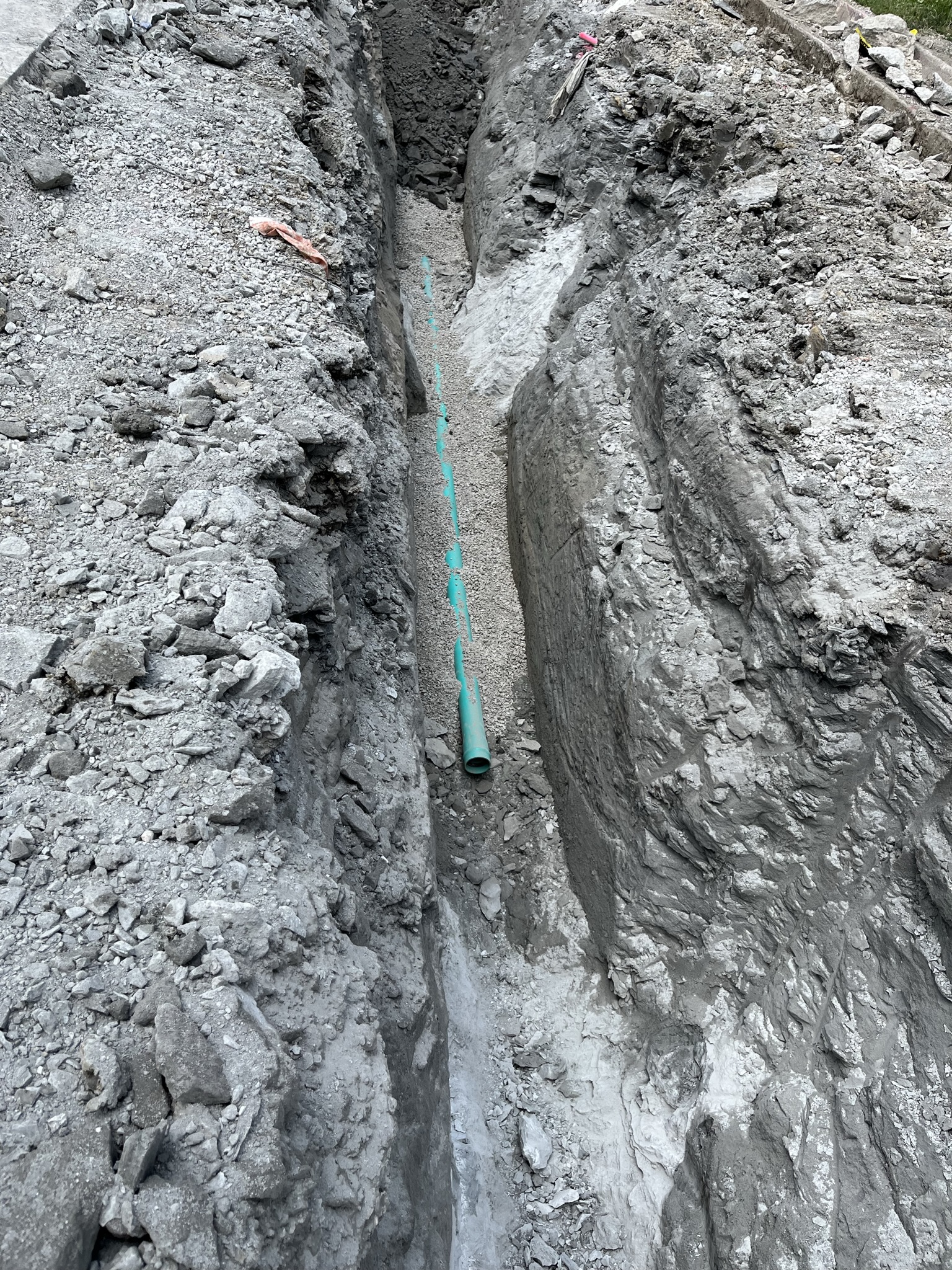

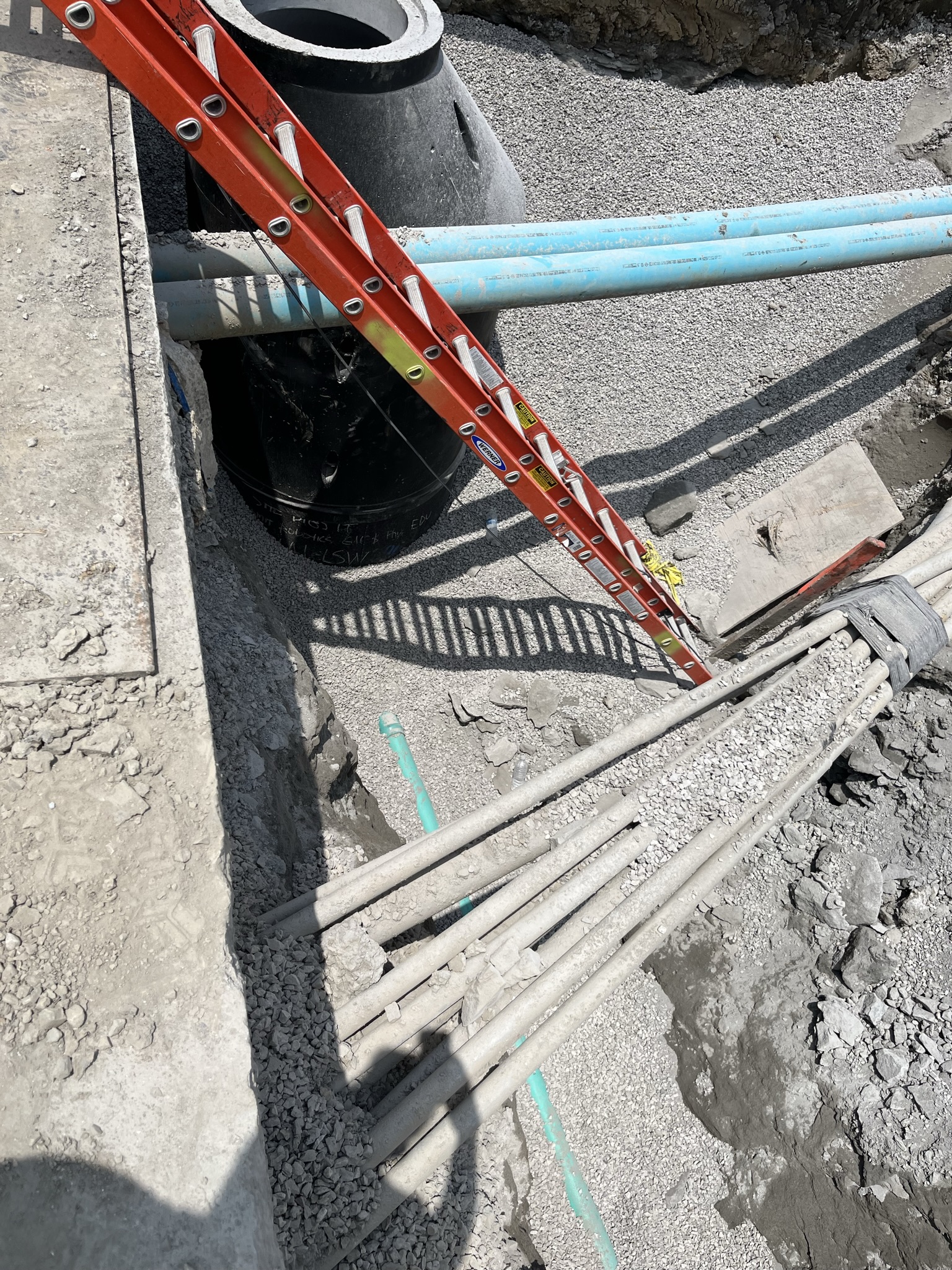

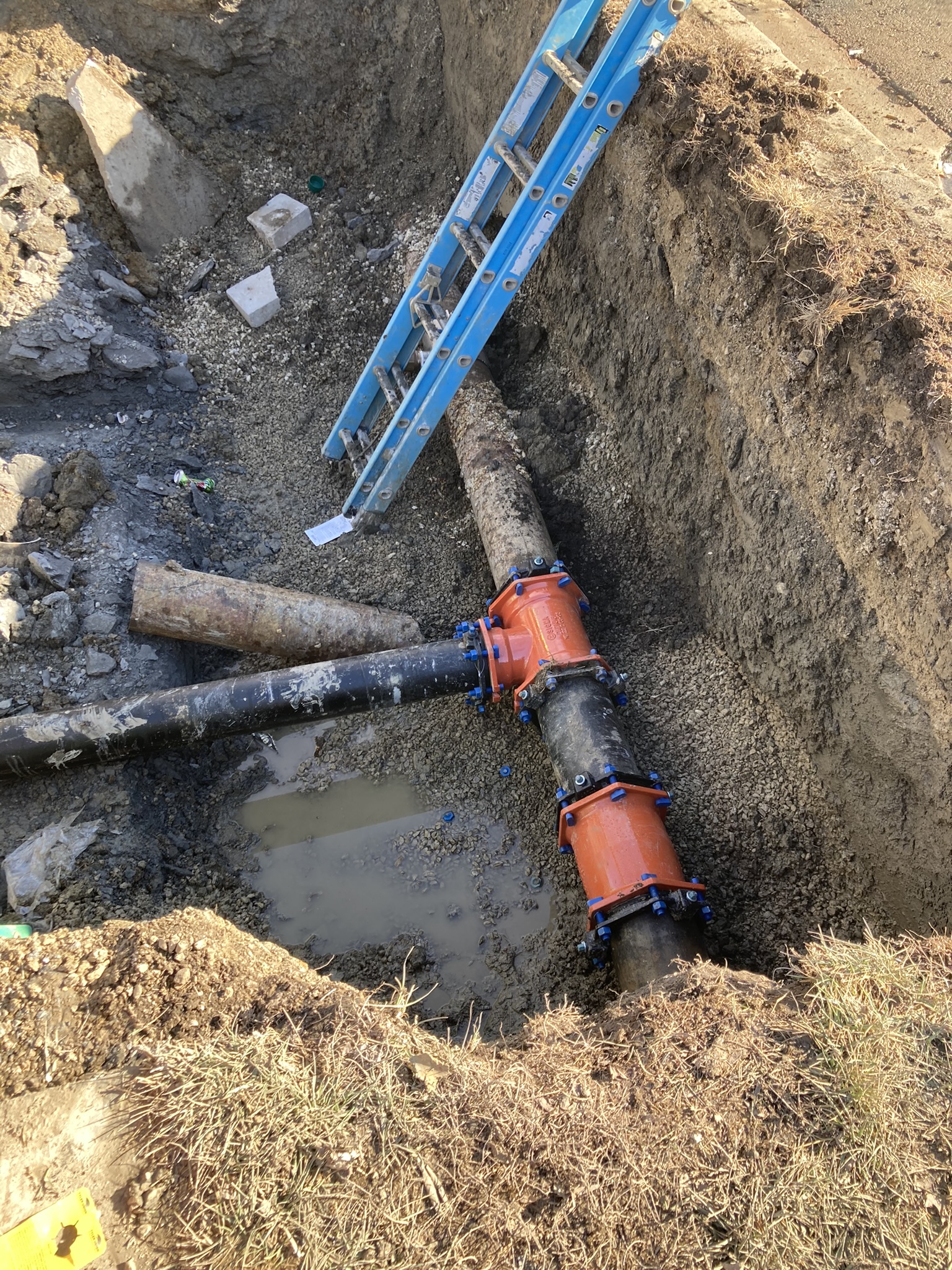

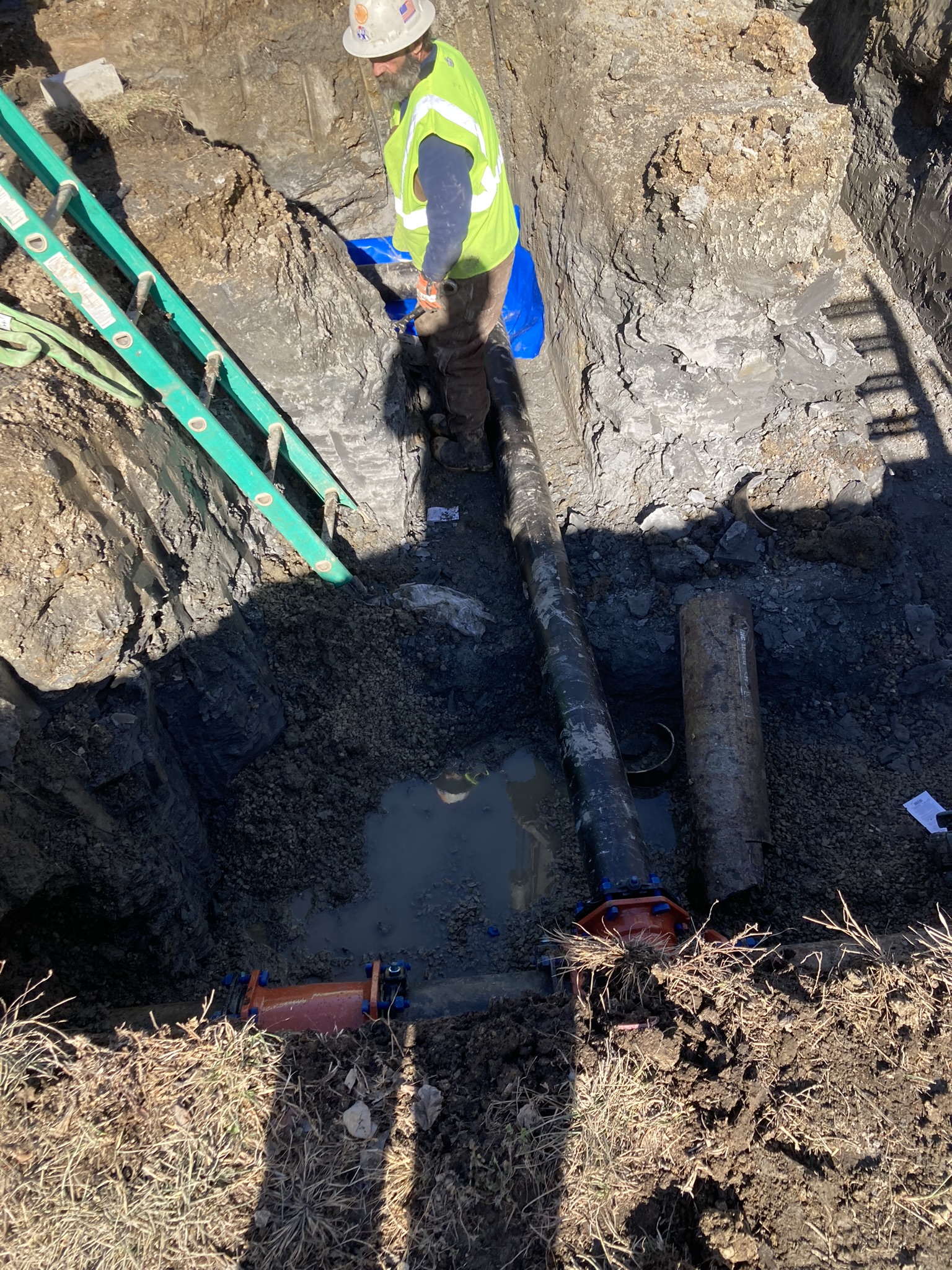

12-20-22 RH. Sanitary Sewer started being installed at station 2+53. Contractor ran into shale so will have to break it out to continue to install pipe. Contractor is also going to be bringing in fill to cover pipe after aggregate is added for bedding and around pipe.
Erosion Control Inspection Residential Partial 12/20/2022
Misc
Informational
12/20/2022
12-20-22 RH. Erosion control is up and in working order.

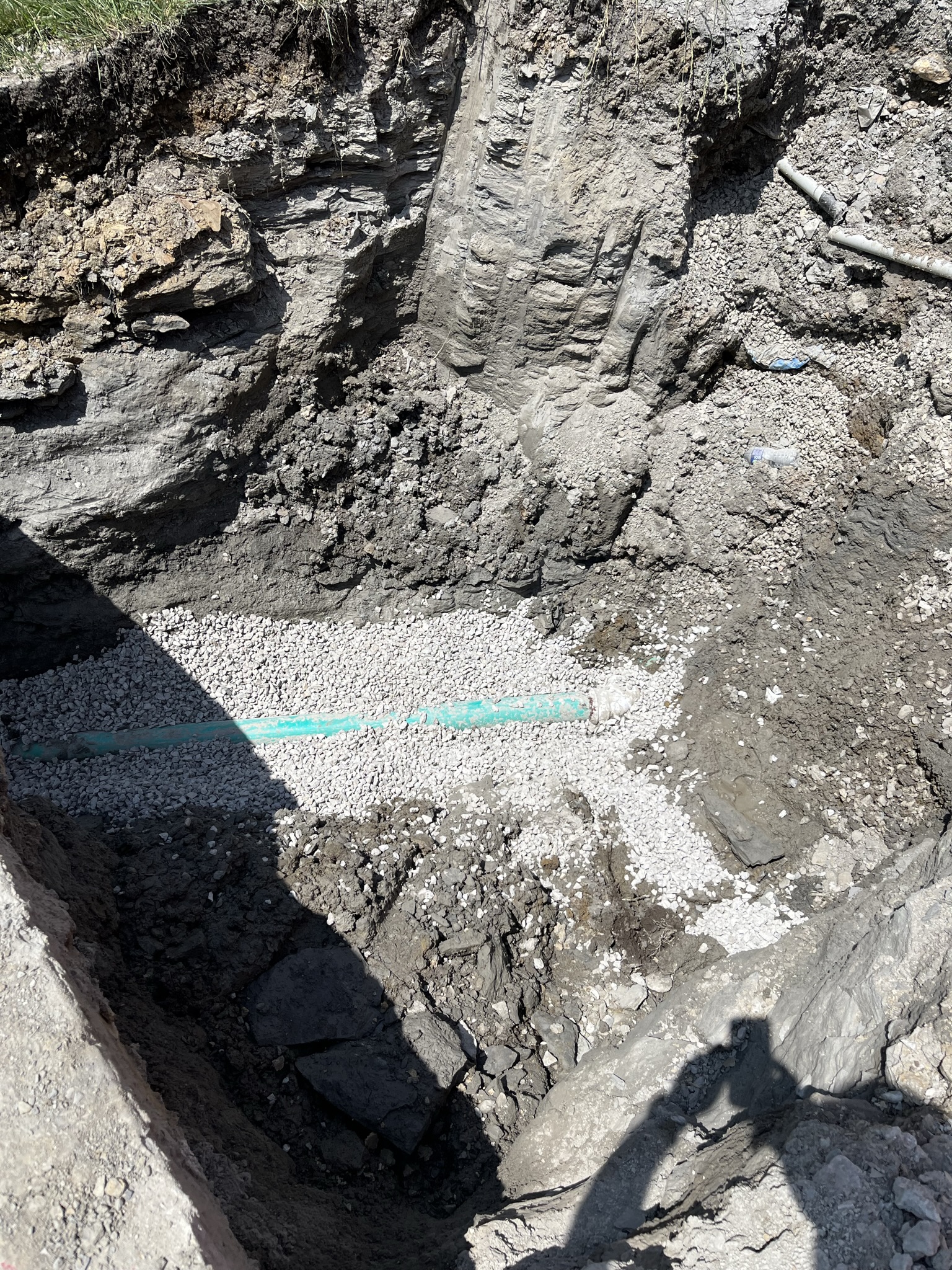

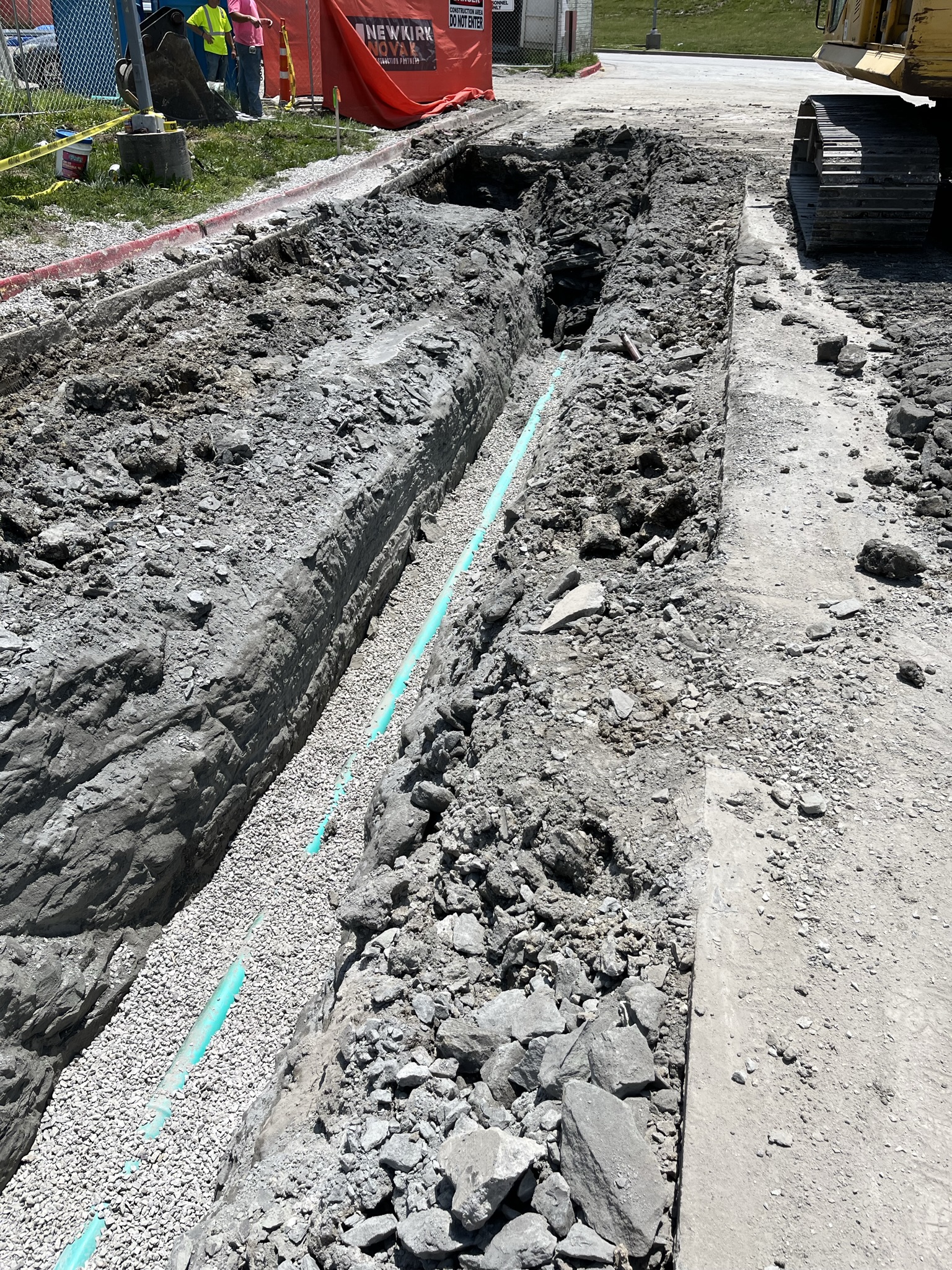

Storm Sewer Construction Inspection Partial 12/20/2022
Misc
Corrective Action Required
12/20/2022

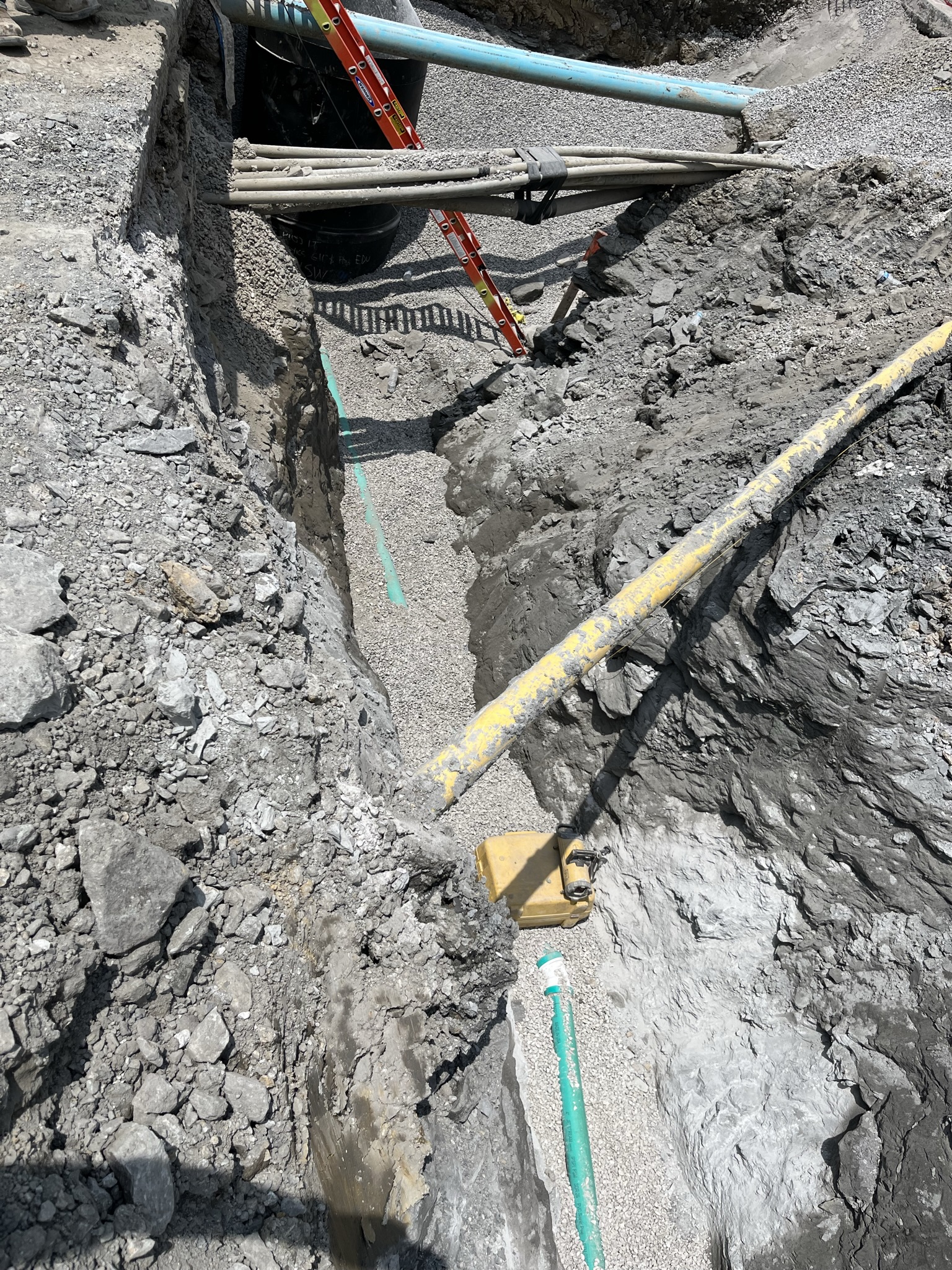

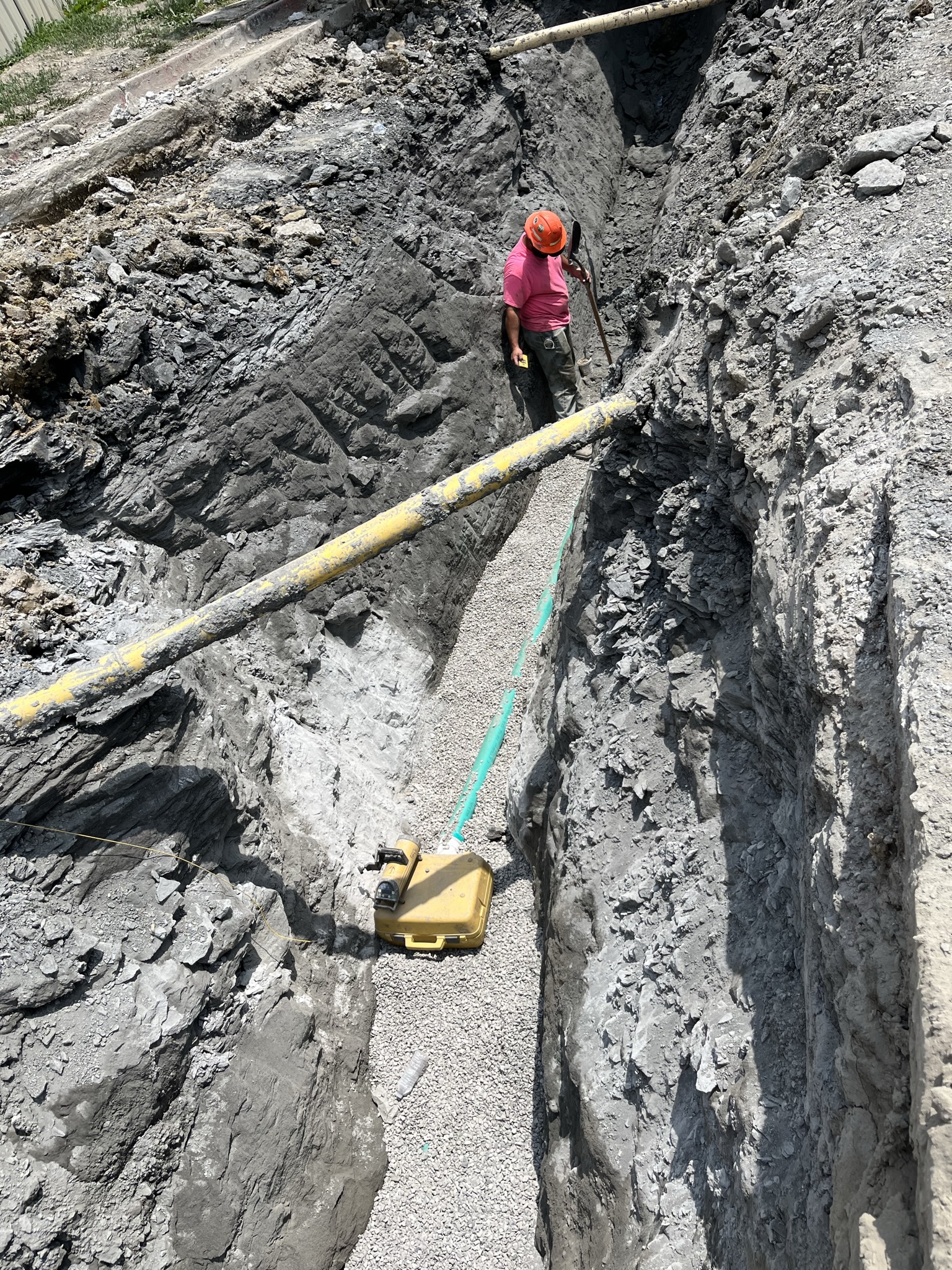

12-20-22 RH. Storm started to be placed today with A1. Contractor had to break out rock to start placing and make bedding. Contractor cut into exciting storm place.
Sewer Service Inspection Partial 12/21/2022
Misc
Informational
12/20/2022
12-20-22 RH. Sanitary Sewer started being installed at station 2+53. Contractor ran into shale so will have to break it out to continue to install pipe. Contractor is also going to be bringing in fill to cover pipe after aggregate is added for bedding and around pipe. 12-21-22 RH. Sanitary Line was ran to the MH 510 before the turn. Work will continue later when building starts.
Storm Sewer Construction Inspection Partial 12/21/2022
Misc
Corrective Action Required
12/20/2022
12-20-22 RH. Storm started to be placed today with A1. Contractor had to break out rock to start placing and make bedding. Contractor cut into exciting storm place. 12-21-22 RH. Storm will continue on Line A after A1 was installed.
Storm Sewer Construction Inspection Partial 12/21/2022
Misc
Corrective Action Required
12/21/2022
12-20-22 RH. Storm started to be placed today with A1. Contractor had to break out rock to start placing and make bedding. Contractor cut into exciting storm place. 12-21-22 RH. Storm will continue on Line A after A1 was installed. Storm on Line A went out 40’ and stoped due other work on parking lot needing to be completed first. 7-20-23 BR 100' of storm sewer installed on south side of building to connect with roof gutters.
Erosion Control Inspection Residential Partial 12/27/2022
Misc
Informational
12/20/2022
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order.
Water Line - Construction Inspection Partial 12/27/2022
Misc
Informational
12/27/2022
12-27-22 RH. Contractor is planning to start placing water line today. Due to the cold temperatures equipment was not wanting to start up today.
Water Line - Construction Inspection Partial 12/28/2022
Misc
Informational
12/27/2022
12-27-22 RH. Contractor is planning to start placing water line today. Due to the cold temperatures equipment was not wanting to start up today. 12-28-22 RH. Contractor placed water line and is setting up to cut in T tomorrow for the fire hydrant.

Water Line - Construction Inspection Partial 12/29/2022
Misc
Informational
12/28/2022
12-27-22 RH. Contractor is planning to start placing water line today. Due to the cold temperatures equipment was not wanting to start up today. 12-28-22 RH. Contractor placed water line and is setting up to cut in T tomorrow for the fire hydrant. 12-29-22 RH. Contractor has tap placed on the main by the water department. They then shut down the main water system to place the T on the main to connect the new fire hydrant.
Erosion Control Inspection Residential Partial 01/03/2023
Misc
Informational
12/27/2022
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order.

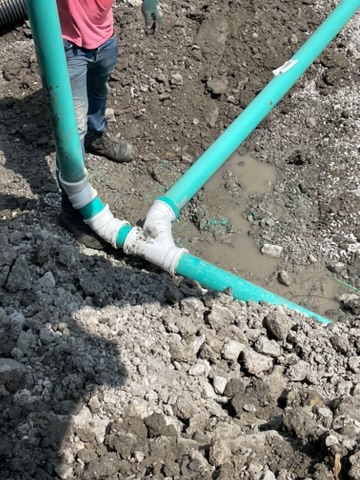

Water Line - Construction Inspection Passed 01/04/2023
Misc
Informational
12/29/2022
12-27-22 RH. Contractor is planning to start placing water line today. Due to the cold temperatures equipment was not wanting to start up today. 12-28-22 RH. Contractor placed water line and is setting up to cut in T tomorrow for the fire hydrant. 12-29-22 RH. Contractor has tap placed on the main by the water department. They then shut down the main water system to place the T on the main to connect the new fire hydrant.
Erosion Control Inspection Residential Partial 01/09/2023
Misc
Informational
01/03/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order.
Footing Inspection - Commercial Partial 1/11/2023 (1:00) 1/11/2023 01/11/2023
Misc
Corrective Action Required
01/11/2023
- footing partial East side map H, 1-3 OK CITY STAMPED PLANS MUST BE ON SITE.
Footing Inspection - Commercial Partial 1/13/2023 (9:00) 1/13/2023 01/13/2023
Misc
Informational
01/13/2023
CITY STAMPED PLANS MUST BE ON SITE. H 1-3 okay line 3 H-C just shy of B okay line 1 H-G okay line E center pad okay
Footing Inspection - Commercial Partial 1/13/2023 01/13/2023
Misc
Informational
01/13/2023
CITY STAMPED PLANS MUST BE ON SITE. H 1-3 okay line 3 H-C just shy of B okay line 1 H-G okay line C,D,E,F,G center pad okay
Footing Inspection - Commercial Passed 1/17/2023 (10:30) 1/17/2023 01/17/2023
Misc
Resolved
01/17/2023
CITY STAMPED PLANS MUST BE ON SITE. H 1-3 okay line 3 H-C just shy of B okay line 1 H-G okay line C,D,E,F,G center pad okay

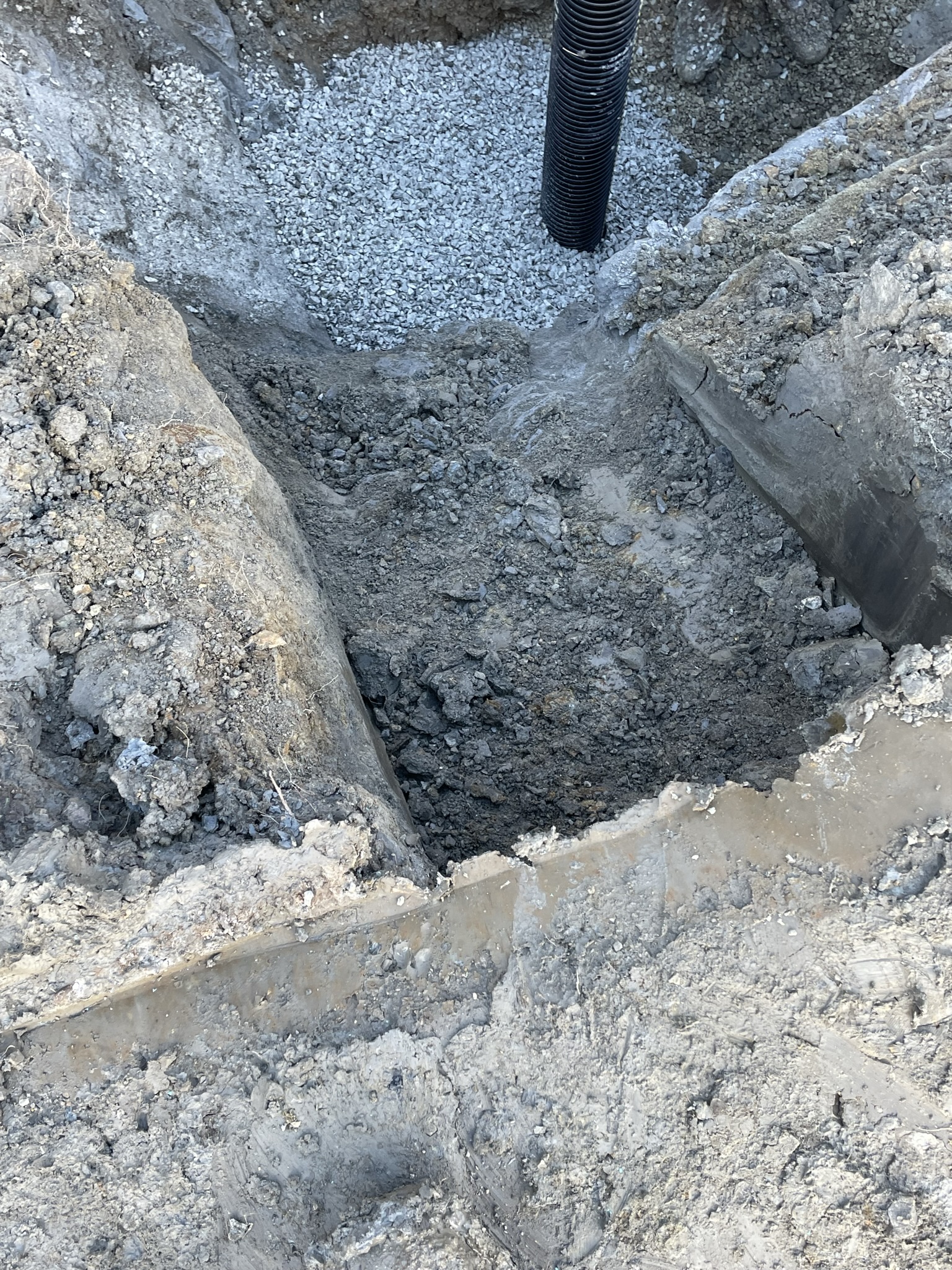

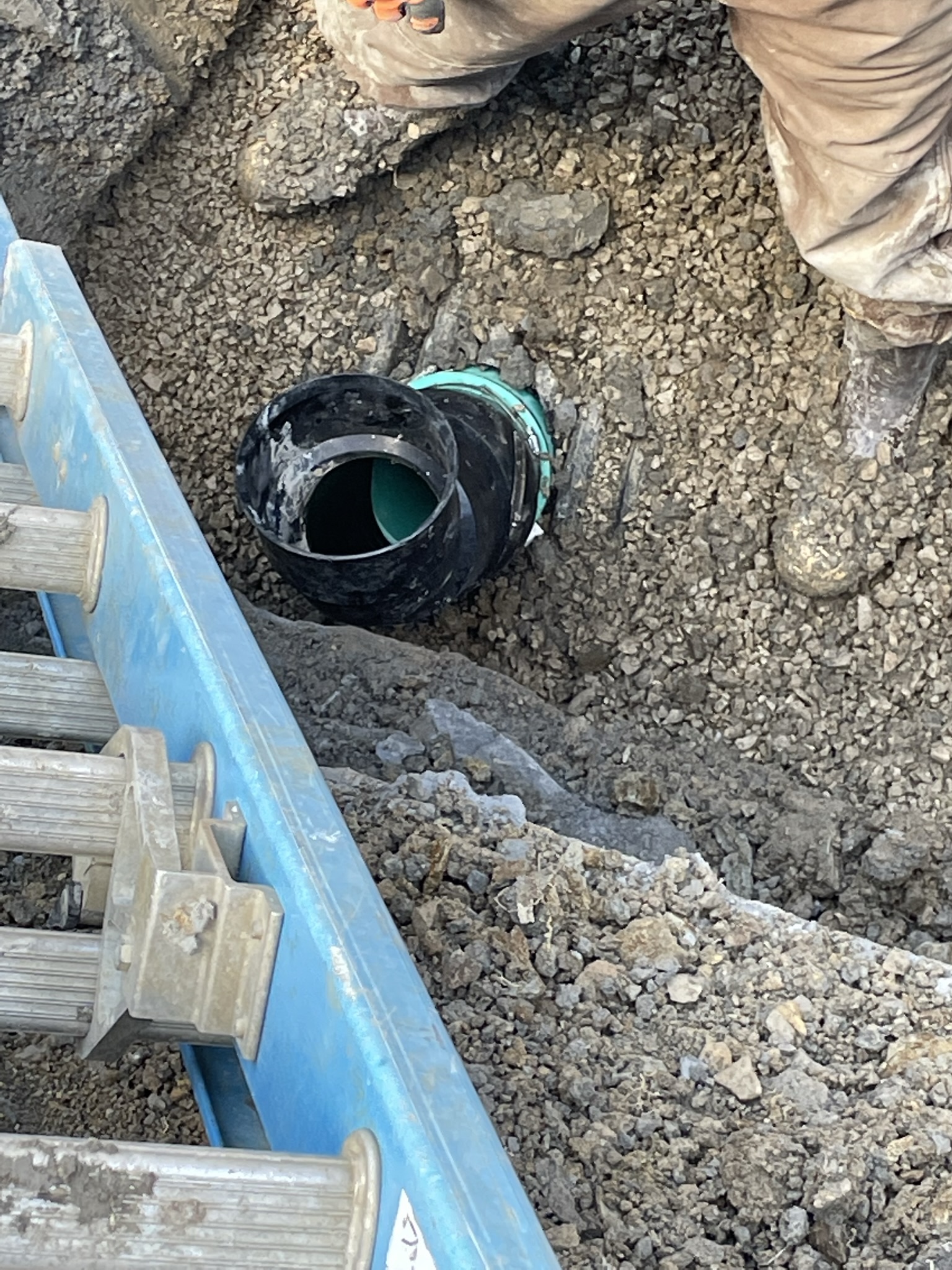

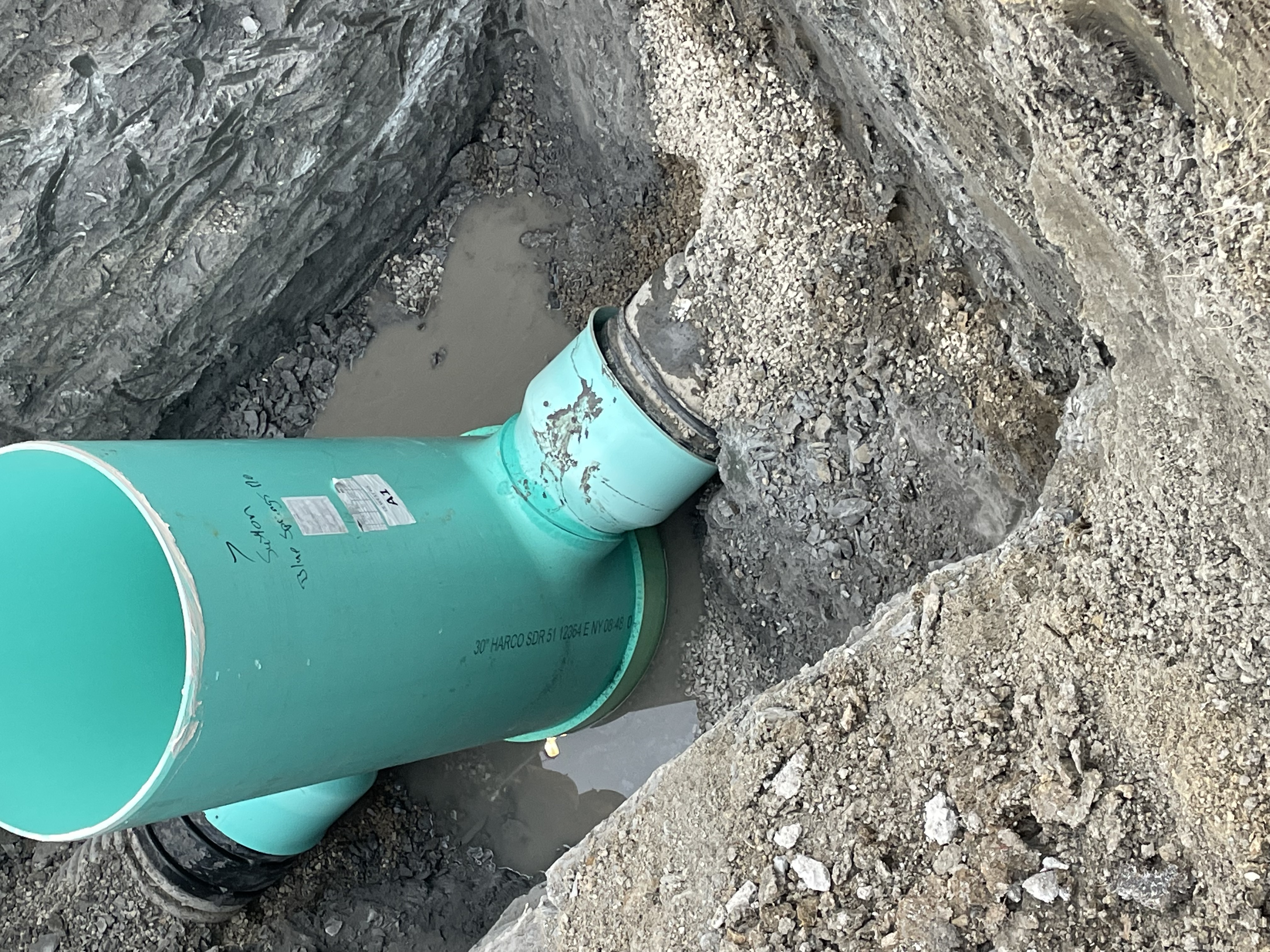

Underslab Plumbing Inspection - Commercial Passed 1/24/2023 1/24/2023 01/24/2023
Footing Inspection - Commercial Passed 1/24/2023 (10:00) 1/24/2023 01/24/2023
Misc
Informational
01/24/2023
- FOOTING FOR RETAINING WALL
Erosion Control Inspection Residential Partial 1/25/2023 1/25/2023 01/25/2023
Misc
Informational
01/09/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance
Foundation Inspection - Commercial Partial 1/27/2023 (10:00) 1/27/2023 01/27/2023
Misc
Informational
01/27/2023
foundation wall for retaining wall okay.

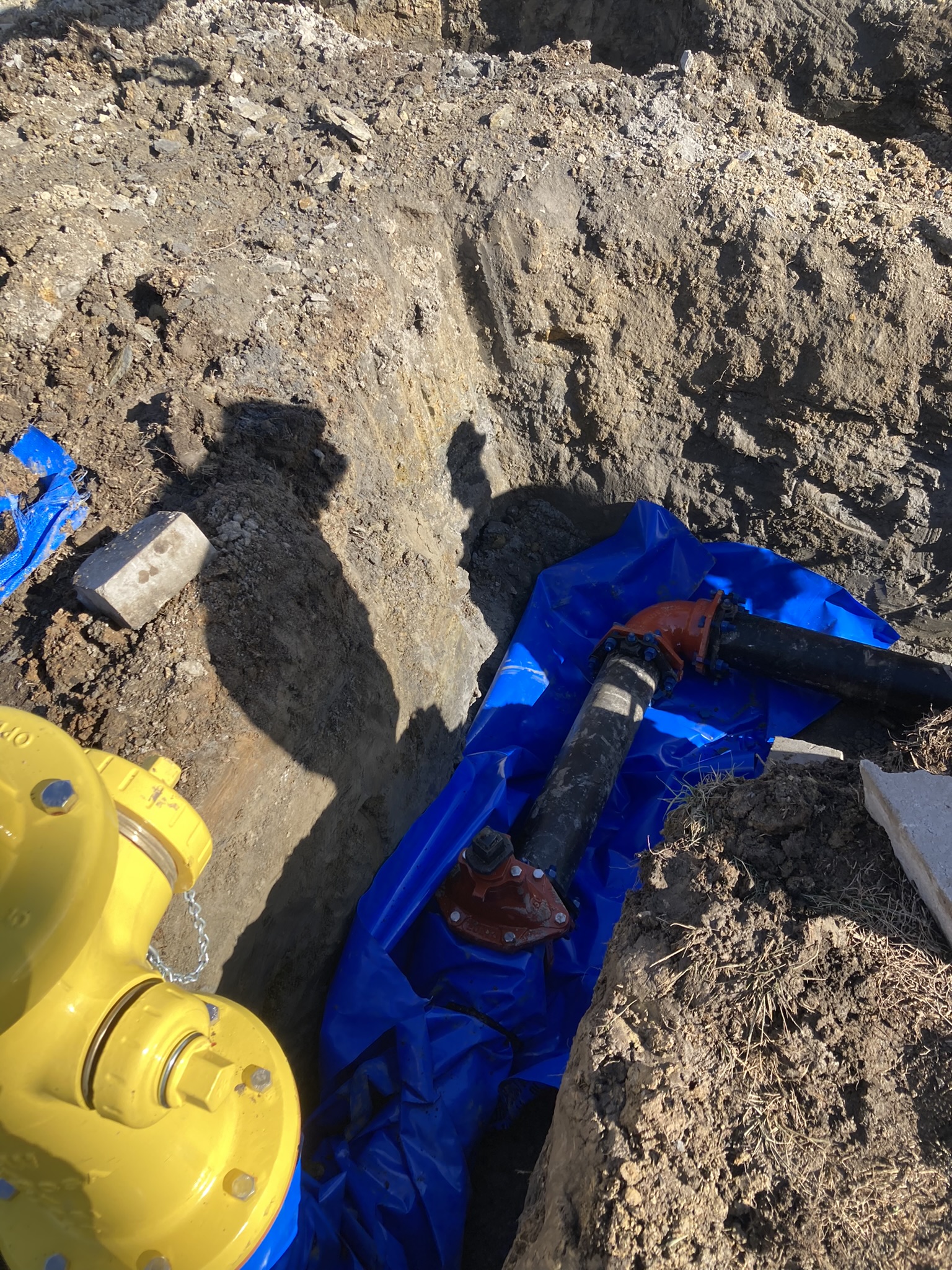

Underground Electrical Inspection - Commercial Passed 1/27/2023 1/27/2023 01/27/2023
Underslab Electrical Inspection - Commercial Passed 1/27/2023 01/27/2023
Erosion Control Inspection Residential Partial 01/30/2023
Misc
Informational
01/25/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order.
Erosion Control Inspection Residential Partial 02/22/2023
Misc
Informational
01/30/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Residential Partial 02/27/2023
Misc
Informational
02/22/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order.
Site Visit Partial 3/2/2023 3/2/2023 03/02/2023
Misc
Corrective Action Required
03/02/2023
3-2-23 RH. No work being completed on site today for development.
Erosion Control Inspection Residential Partial 3/3/2023 3/3/2023 03/03/2023
Misc
Informational
02/27/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Residential Partial 03/14/2023
Misc
Informational
03/03/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 7-19-23 BR Erosion Control is up and working order
Erosion Control Inspection Residential Partial 3/17/2023 3/17/2023 03/17/2023
Misc
Informational
03/14/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order.
Erosion Control Inspection Residential Partial 3/22/2023 3/22/2023 03/22/2023
Misc
Informational
03/17/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order.
Site Visit Partial 3/27/2023 3/27/2023 03/27/2023
Misc
Corrective Action Required
03/02/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today.
Site Visit Partial 3/30/2023 3/30/2023 03/30/2023
Misc
Corrective Action Required
03/27/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. Now work being completed for development in the AM.
Site Visit Partial 3/31/2023 3/31/2023 03/31/2023
Misc
Corrective Action Required
03/30/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. Now work being completed for development in the AM. 3-31-23 RH. Now work for development in the AM.

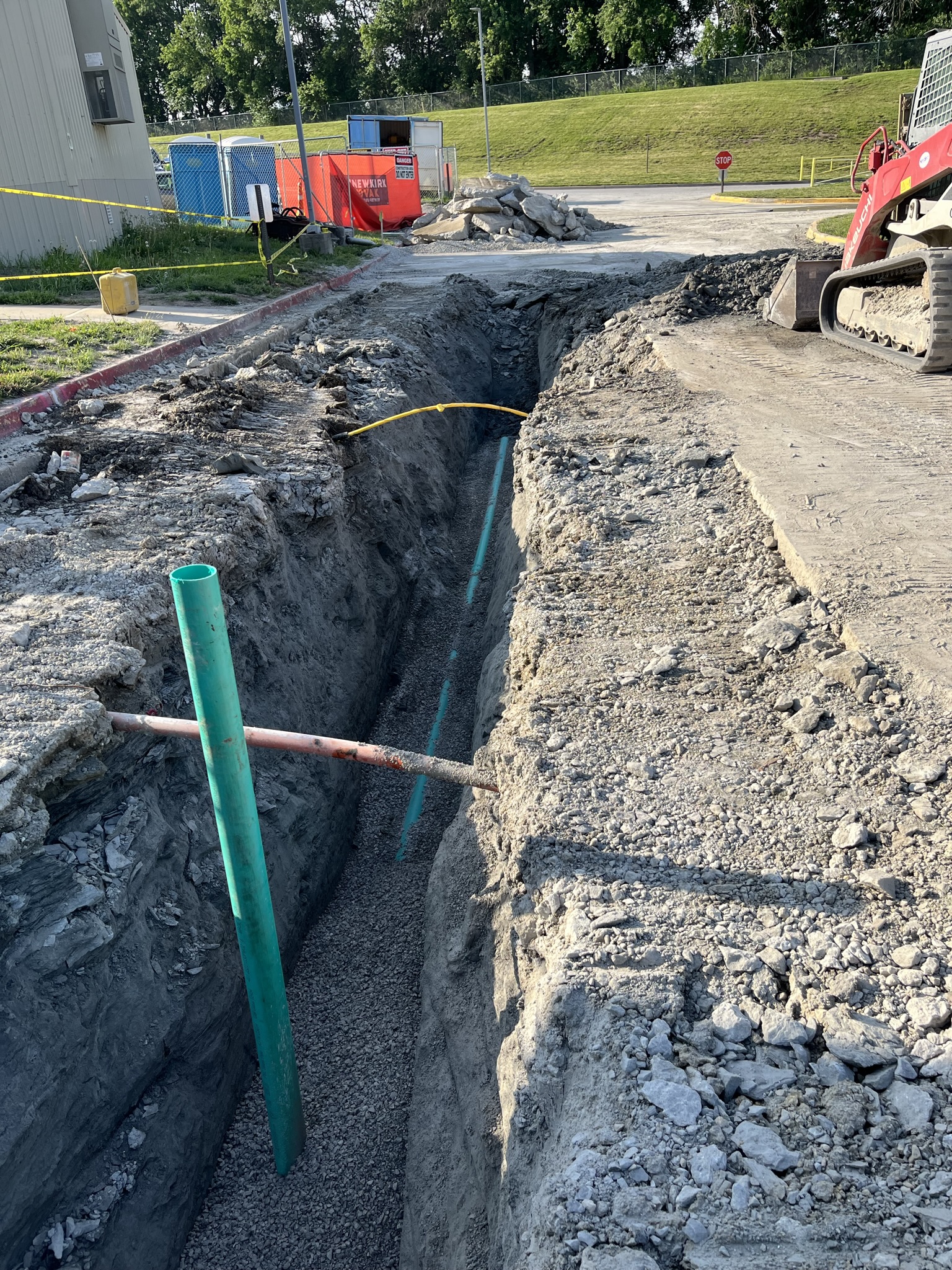

Erosion Control Inspection Residential Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Informational
03/22/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order.
Site Visit Partial 4/3/2023 4/3/2023 04/03/2023
Misc
Corrective Action Required
03/31/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for deelopmnt in the AM.
Site Visit Partial 04/10/2023
Misc
Corrective Action Required
04/03/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for deelopmnt in the AM. 4-10-23 RH. No Work for deelopmnt in the AM.
Site Visit Partial 04/12/2023
Misc
Corrective Action Required
04/10/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for devlopmnt in the AM. 4-10-23 RH. No Work for devlopmnt in the AM. 4-12-23 RH. No Work for devlopmnt in the AM.
Site Visit Partial 04/19/2023
Misc
Corrective Action Required
04/12/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM.
Erosion Control Inspection Residential Partial 4/20/2023 4/20/2023 04/20/2023
Misc
Informational
04/03/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in workign order.
Site Visit Partial 04/21/2023
Misc
Corrective Action Required
04/19/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM.
Erosion Control Inspection Residential Partial 4/24/2023 4/24/2023 04/24/2023
Misc
Informational
04/20/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in workign order. 4-24-23 RH. Erosion control is up and in workign order. 7-5-23 BR Erosion control is up and in workign order
Site Visit Partial 04/26/2023
Misc
Corrective Action Required
04/21/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM.
Site Visit Partial 04/27/2023
Misc
Corrective Action Required
04/26/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM.
Site Visit Partial 05/03/2023
Misc
Corrective Action Required
04/27/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM.
Site Visit Partial 05/05/2023
Misc
Corrective Action Required
05/03/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM.
Erosion Control Inspection Residential Partial 05/16/2023
Misc
Informational
04/24/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-16-23 RH. Erosion Control is up and in working order. 7-31-23 BR Erosion control is up and working order
Site Visit Partial 05/18/2023
Misc
Corrective Action Required
05/05/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM.
Site Visit Partial 05/19/2023
Misc
Corrective Action Required
05/18/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM.
Erosion Control Inspection Residential Partial 05/22/2023
Misc
Informational
05/16/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-16-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Residential Partial 05/25/2023
Misc
Informational
05/22/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-16-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order. 5-25-23 RH. Erosion Control is up and in working order.
Erosion Control Inspection Residential Partial 6/5/2023 6/5/2023 06/05/2023
Misc
Informational
05/25/2023
12-20-22 RH. Erosion control is up and in working order. 12-27-22 RH. Erosion control is up and in working order. 1-3-23 DP. Erosion control is up and in working order. 1-9-22 RH. Erosion Control is up and in working order. 1-25-23 PS Erosion control within compliance 1-30-23 RH. Eroison contorl is up and in working order. 2-22-23 RH. Erosion Control is up and in working order. 2-27-23 RH. Erosion Control is up and in working order. 3-3-23 RH. Erosion Control is up and in working order. 3-14-23 RH. Erosion Control is up and in working order. 3-17-23 RH. Erosion control is in working order. 3-22-23 RH. After the rain even from yesterday erosion control is in working order. 4-3-23 RH. Erosion control is up and in working order. 4-20-23 RH. Erosion control is up and in working order. 4-24-23 RH. Erosion control is up and in working order. 5-16-23 RH. Erosion Control is up and in working order. 5-22-23 RH. Erosion Control is up and in working order. 5-25-23 RH. Erosion Control is up and in working order. 6-5-23 BR Erosion control is up and working order. 6-12-23 BR Erosion Control is up and working order 6-19-23 BR Erosion Control is up and working order 6-27-23 BR Erosion Control is up 7-5-23 BR Erosion Control is up and working order
Site Visit Partial 6/6/2023 6/6/2023 06/06/2023
Misc
Informational
06/06/2023
3-2-23 RH. No work being completed on site today for development. 3-27-23 RH. No work for development today. 3-30-23 RH. No work being completed for development in the AM. 3-31-23 RH. No work for development in the AM. 4-3-23 RH. No Work for development in the AM. 4-10-23 RH. No Work for development in the AM. 4-12-23 RH. No Work for development in the AM. 4-19-23 RH. No Work for development in the AM. 4-21-23 RH. No Work for development in the AM. 4-26-23 RH. No work for development in the AM. 4-26-23 RH. No work for development in the AM. 5-3-23 RH. No work for development in the AM. 5-5-23 RH. No work for development in the AM. 5-18-23 RH. No work for development in the AM. 5-19-23 RH. No work on site for development in the AM. 6-6-23 BR Saintary sewer line is under construction
Sewer Service Inspection Partial 06/08/2023
Misc
Informational
12/21/2022
12-20-22 RH. Sanitary Sewer started being installed at station 2+53. Contractor ran into shale so will have to break it out to continue to install pipe. Contractor is also going to be bringing in fill to cover pipe after aggregate is added for bedding and around pipe. 12-21-22 RH. Sanitary Line was ran to the MH 510 before the turn. Work will continue later when building starts. 6-8-23 BR Sewer main has started installing phase 2 45 ft of pipe was laid. 6-13-23 BR Sewer main has installed 45 ft of pipe to the 1st clean out line. 6-14-23 BR Sewer main has installed 2nd clean out line.
In-wall Inspection Passed 6/15/2023 6/15/2023 06/15/2023
Pavement-Proof Roll Partial 6/22/2023 6/22/2023 06/22/2023
Misc
Informational
06/22/2023
6-22-23 BR LSWHS Driveway was compacted and poof roll pass ready for concrete 8-2-23 BR Driveway was proof roll around the building and pass ready for concrete. 8-3-23 BR Prior to rain we receive today the subgrade is questionable school district is aware of the issue.
Sewer Service Inspection Passed 6/15/2023 6/15/2023 06/23/2023
Misc
Informational
06/08/2023
12-20-22 RH. Sanitary Sewer started being installed at station 2+53. Contractor ran into shale so will have to break it out to continue to install pipe. Contractor is also going to be bringing in fill to cover pipe after aggregate is added for bedding and around pipe. 12-21-22 RH. Sanitary Line was ran to the MH 510 before the turn. Work will continue later when building starts. 6-8-23 BR Sewer main has started installing phase 2 45 ft of pipe was laid. 6-14-23 BR Sewer main had 1st and 2nd clean out installed. Sewer main is instaled and ready for aggregate to be installed and then concreted. 6-23-23 BR Sewer main is installed and working order.
Above Ceiling Inspection Failed 6/30/2023 6/30/2023 06/30/2023
Misc
Corrective Action Required
06/30/2023
Only inspected above bathrooms, complete mechanical.
Above Ceiling Inspection Partial 7/6/2023 07/06/2023
Misc
Corrective Action Required
06/30/2023
Only inspected above bathrooms, complete mechanical. re inspected bathrooms after lighting installed. Shawn Hoffman 07/06/2023 1:59 PM
Above Ceiling Inspection Partial 7/7/2023 7/7/2023 07/07/2023
Misc
Informational
07/07/2023
Only inspected above bathrooms, complete mechanical. re inspected bathrooms after lighting installed. Shawn Hoffman 07/06/2023 1:59 PM - inspected kitchen area.
Gas Service Inspection - Commercial Passed 7/18/2023 07/18/2023
Water Line - Hydrostatic Test Passed 07/18/2023
Misc
Informational
07/18/2023
7-18-23 BR n/a
Storm Sewer Construction Inspection Passed 07/26/2023
Misc
Corrective Action Required
12/21/2022
12-20-22 RH. Storm started to be placed today with A1. Contractor had to break out rock to start placing and make bedding. Contractor cut into exciting storm place. 12-21-22 RH. Storm will continue on Line A after A1 was installed. Storm on Line A went out 40’ and stopped due other work on parking lot needing to be completed first. 1-3-23 RH. Roof Drain was cut into the exciting system for future tie into the new building. 7-18-23 BR Roof drain is tie into storm sewer coming from the building. As while storm sewer was installed on north side of building.
Occupancy Inspection - Codes Commercial Failed 8/11/2023 8/11/2023 08/11/2023
Misc
Corrective Action Required
08/11/2023
-install all door thresholds no more than 1/4” transitions -complete electrical through out -open junction boxes in plumbing room -complete back-flow piping -complete all accessible signage -permanent signage throughout -GFCI outlets in bathrooms not working -maximum distance to reflective edge 40” see mens bathroom -drinking fountains to be 27” minimum knee clearance -land electrical to a box in break room area -GFCI protection for all outlets with in 6’ of sink See kitchenette left side -complete permanent labels for service panels -missing permanent equipment for electrical panels -missing main breaks at H1W & both 120 panels -label all rtu -install all wood paneling ensure boxes are flush *OKAY TO SET UP EQUIPMENT*
Alarm Test Passed 8/11/2023 08/11/2023
Occupancy Inspection - Fire Failed 8/11/2023 8/11/2023 08/11/2023
Occupancy Inspection - Engineering Temporary C of O 8/21/2023 8/21/2023 08/21/2023
Misc
Corrective Action Required
08/11/2023
Punchlist of Items needed for Temporary Occupancy -Complete Sidewalk that was removed during Water Tye In and replace damged panels -Complete sidewalk on South Side of Building -Grade Site Punchlist needed for Final Occupancy -Clean up all trash and debris on site -Vegetation Punchlist items for Temporary Occupancy pass on 8-21-23 Punchlist items are completed BR 8-2-23
Occupancy Inspection - Codes Commercial Ready for Temp CO 8/21/2023 8/21/2023 08/21/2023
Misc
Corrective Action Required
08/11/2023
-install all door thresholds no more than 1/4” transitions -permanent signage throughout -complete permanent labels for service panels -missing permanent equipment for electrical panels -missing main breaks at H1W & both 120 panels -provide permanent label at all rtu -install all wood paneling ensure boxes are flush
Occupancy Inspection - Planning Passed 8/21/2023 8/21/2023 08/21/2023
Occupancy Inspection - Water Utilities Passed 8/21/2023 8/21/2023 08/21/2023
Occupancy Inspection - Fire Passed 8/21/2023 8/21/2023 08/24/2023
Occupancy Inspection - Codes Commercial Ready for Temp CO 9/20/2023 09/20/2023
Misc
Corrective Action Required
08/21/2023
-install all door thresholds no more than 1/4” transitions -permanent signage throughout -complete permanent labels for service panels -missing permanent equipment for electrical panels -missing main breaks at H1W & both 120 panels -provide permanent label at all rtu -install all wood paneling ensure boxes are flush
Occupancy Inspection - Engineering Passed 10/16/2023
Misc
Resolved
10/16/2023
Punchlist of Items needed for Temporary Occupancy -Complete Sidewalk that was removed during Water Tye In and replace damged panels -Complete sidewalk on South Side of Building -Grade Site Punchlist needed for Final Occupancy -Clean up all trash and debris on site -Vegetation
Occupancy Inspection - Engineering Temporary C of O 10/19/2023
Misc
Corrective Action Required
08/11/2023
Punchlist of Items needed for Temporary Occupancy -Complete Sidewalk that was removed during Water Tye In and replace damged panels -Complete sidewalk on South Side of Building -Grade Site Punchlist needed for Final Occupancy/ Complete 10-16-23 -Clean up all trash and debris on site -Vegetation
Occupancy Inspection - Codes Commercial Full C of O 1/26/2024 01/26/2024
Misc
Resolved
01/26/2024
-install all door thresholds no more than 1/4” transitions -permanent signage throughout -complete permanent labels for service panels -missing permanent equipment for electrical panels -missing main breaks at H1W & both 120 panels -provide permanent label at all rtu -install all wood paneling ensure boxes are flush
Documents & Images
Date Uploaded File Type Document Name
10/21/2022 Application Form Commercial Permit Application_LSW_Signed
10/21/2022 Plans 220909_LSW_LSN Bid Set_REDUX
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 1 OF 3
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 2 OF 3
10/21/2022 Specifications LSR7 Robotics & GiC Project Manual - VOLUME 3 OF 3
11/02/2022 Letter Fire Building Plan Review
11/04/2022 Letter DS P/R Corrections Document
11/11/2022 Engineer Report/Study 22-5547 LS West High School Robotics Building Geotech Report
11/11/2022 Specifications 077200 - ROOF ACCESSORIES_ASI-01_ISS03
11/11/2022 Plans 221110 LSW Permit Set
11/11/2022 Letter Lee's Summit West Permit Responses
11/11/2022 Letter LSR7 Robotics - ASI 001-ISS 003 - LSW Narrative
11/16/2022 Letter Fire Building Plan Review
11/18/2022 Letter License Tax Bill
11/18/2022 Approved Plans approved - 221110 LSW Permit Set
11/23/2022 Letter 22-1123_Lee Summit West Permit Comments
12/02/2022 Approved Plans APPROVED LS WEST ROBOTICS - CIVIL
12/06/2022 Receipt Receipt for transaction: 2022-009315
12/06/2022 Letter DS Building Permit
12/20/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY
12/21/2022 Letter INSPECTION SUMMARY

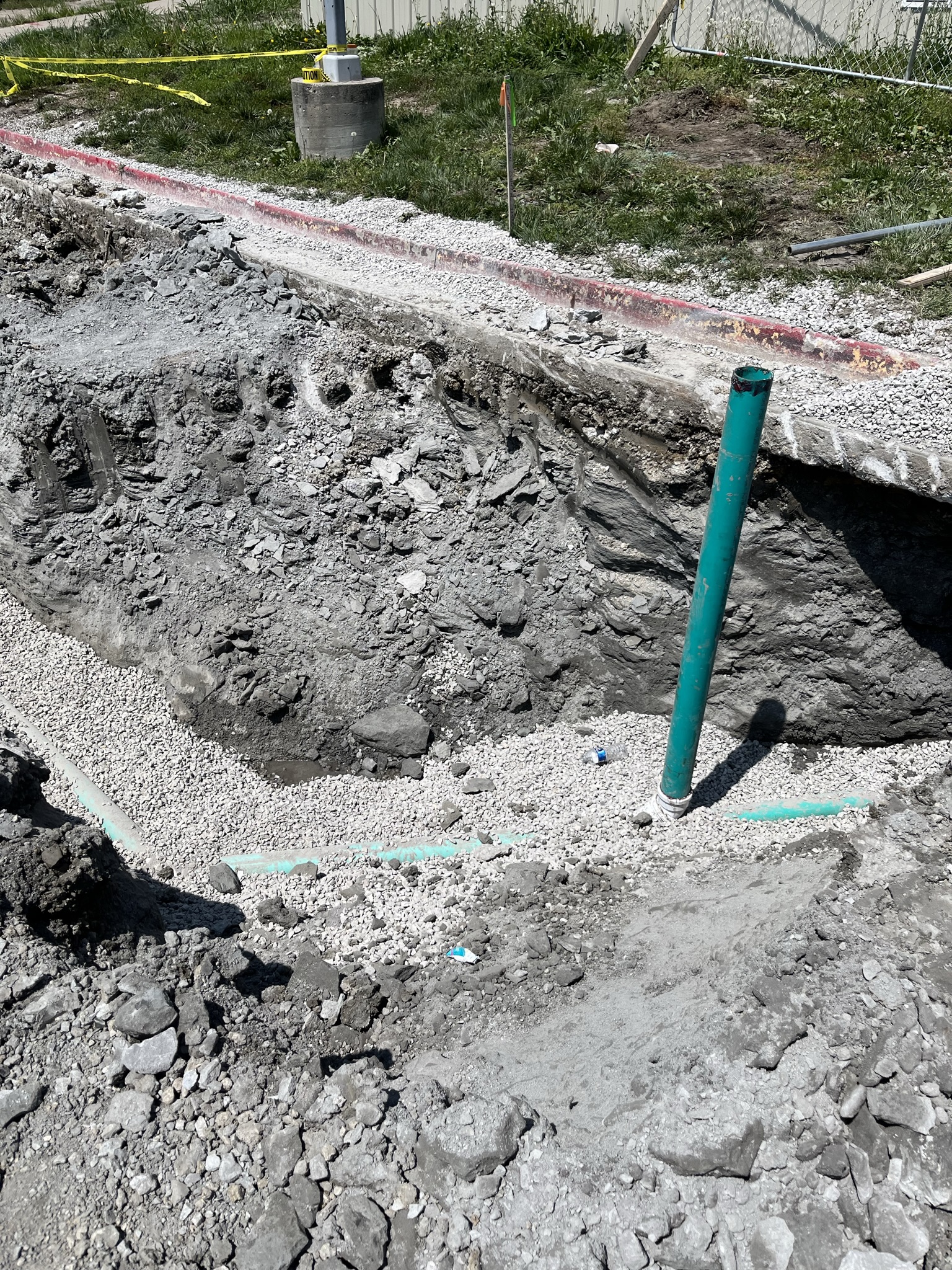

12/21/2022 12-21-22 Storm Connection
12/21/2022 Letter INSPECTION SUMMARY
12/27/2022 Letter INSPECTION SUMMARY
12/27/2022 Letter INSPECTION SUMMARY
12/28/2022 Letter INSPECTION SUMMARY
12/29/2022 Letter INSPECTION SUMMARY
01/03/2023 Water Tie In 12-29-22
01/03/2023 Water Tie In12-29-22
01/03/2023 Water Tie In 12-29-23
01/03/2023 Letter INSPECTION SUMMARY
01/04/2023 Roof Drain Cut In
01/04/2023 Roof Drain Stub
01/04/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/09/2023 Letter INSPECTION SUMMARY
01/11/2023 Letter INSPECTION SUMMARY
01/13/2023 Letter INSPECTION SUMMARY
01/17/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/24/2023 Letter INSPECTION SUMMARY
01/25/2023 Letter INSPECTION SUMMARY
01/30/2023 Letter INSPECTION SUMMARY
02/22/2023 Letter INSPECTION SUMMARY
02/27/2023 Letter INSPECTION SUMMARY
03/02/2023 Letter INSPECTION SUMMARY
03/03/2023 Letter INSPECTION SUMMARY
03/14/2023 Letter INSPECTION SUMMARY
03/17/2023 Letter INSPECTION SUMMARY
03/22/2023 Letter INSPECTION SUMMARY
03/27/2023 Letter INSPECTION SUMMARY
03/30/2023 Letter INSPECTION SUMMARY
03/31/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/10/2023 Letter INSPECTION SUMMARY
04/12/2023 Letter INSPECTION SUMMARY
04/19/2023 Letter INSPECTION SUMMARY
04/20/2023 Letter INSPECTION SUMMARY
04/21/2023 Letter INSPECTION SUMMARY
04/24/2023 Letter INSPECTION SUMMARY
04/26/2023 Letter INSPECTION SUMMARY
04/27/2023 Letter INSPECTION SUMMARY
05/03/2023 Letter INSPECTION SUMMARY
05/05/2023 Letter INSPECTION SUMMARY
05/15/2023 Plans fire plans
05/15/2023 Plans submittal catalog
05/16/2023 Letter INSPECTION SUMMARY
05/18/2023 Letter INSPECTION SUMMARY
05/19/2023 Letter INSPECTION SUMMARY
05/22/2023 Letter INSPECTION SUMMARY
05/25/2023 Letter INSPECTION SUMMARY
05/31/2023 Letter Fire (Alarm) Plan Review Notice
06/05/2023 Letter INSPECTION SUMMARY
06/06/2023 Letter INSPECTION SUMMARY
06/08/2023 Letter INSPECTION SUMMARY
06/13/2023 Letter INSPECTION SUMMARY
06/15/2023 6-14-23
06/15/2023 6-14-23
06/15/2023 6-14-24
06/15/2023 6-14-25
06/15/2023 6-14-26
06/15/2023 6-14-27
06/15/2023 6-14-28
06/15/2023 6-14-29
06/15/2023 6-14-30
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter Fire Building Plan Review
06/15/2023 Letter Fire Building Plan Review
06/15/2023 Letter Fire Building Plan Review
06/15/2023 Letter Fire Building Plan Review
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter INSPECTION SUMMARY
06/15/2023 Letter Fire Building Plan Review
06/20/2023 Letter INSPECTION SUMMARY
06/22/2023 Letter INSPECTION SUMMARY
06/23/2023 Letter INSPECTION SUMMARY
06/28/2023 Letter INSPECTION SUMMARY
06/30/2023 Letter Fire Building Plan Review
06/30/2023 Letter INSPECTION SUMMARY
07/05/2023 Letter INSPECTION SUMMARY
07/07/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/18/2023 Letter INSPECTION SUMMARY
07/19/2023 Letter INSPECTION SUMMARY
07/19/2023 4'' Sewer Y into building
07/19/2023 roof gutter into storm line
07/20/2023 Letter INSPECTION SUMMARY
07/26/2023 Letter INSPECTION SUMMARY
07/31/2023 Letter INSPECTION SUMMARY
08/03/2023 Letter INSPECTION SUMMARY
08/04/2023 3RD Party Insp Report SI Final Letter LSW
08/11/2023 Letter INSPECTION SUMMARY
08/11/2023 Letter INSPECTION SUMMARY
08/21/2023 Letter INSPECTION SUMMARY
08/21/2023 Certificate/License Codes Temporary Certificate of Occupancy
08/21/2023 Receipt Receipt for transaction:2023-006472
09/20/2023 LSW TCO Extension Request Form
09/20/2023 Letter INSPECTION SUMMARY
09/20/2023 Letter INSPECTION SUMMARY
09/20/2023 Certificate/License Codes Temporary Certificate of Occupancy
09/20/2023 Receipt Receipt for transaction:2023-007207
10/03/2023 Letter INSPECTION SUMMARY
10/19/2023 Letter INSPECTION SUMMARY
01/26/2024 Letter Codes Final Certificate of Occupancy
01/26/2024 Letter Field Certificate of Occupancy
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
