Permit Application Status

PRCOM20221422


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary
PRCOM20221422
Building Permit - Commercial
Final Completion
ROBINSON E L JR & LETHA M - TRUSTEES
NEW SHELL BUILDING
SHELL BUILDING FOR FUTURE MEDICAL USE
04/12/2022
05/16/2022
10/22/2022
02/17/2023
Locations
Contacts
CRANE CONSTRUCTION COMPANY, Address:PO BOX 298, Phone:(816) 324-5951
Bruce Mills, Address:bruce@crane-construction.com, Phone:(816) 294-9009
B & C MECHANICAL SERVICES LLC, Address:2008 E SPRUCE CIR STE B, Phone:(913) 681-0088
A & A ELECTRICAL INC, Address:705 SQUIRE CT, Phone:(816) 847-1902
MAYES PLUMBING INC, Address:501 S MCCLEARY RD STE A, Phone:(816) 792-5400
JOE STEWART, Address:125 HIGHLAND PARK AVE, Phone:(816) 830-2754
ROBINSON E L JR & LETHA M - TRUSTEES, Address:37004 E CLINE RD
Reviews
Review Type Outcome Est. Completion Date Completed
Fire Plan Review Approved with Conditions 05/17/2022 05/12/2022
Jim Eden
Address numbers required
Resolved
05/12/2022

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). Action required-All doors shall be posted with suite/address number. Verified at inspection.
Knox box required
Resolved
05/12/2022

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. Action required- Provide a Knox box at the water utility room. The backflow valve supplying the private hydrant shall be chained and locked in the open position with a key to the room and lock provided in the Knox Box.
Fire protection equipment identification
Informational
05/12/2022

2018 IFC 510.1- Identification. Fire protection equipment shall be identified in an approved manner. Rooms containing controls for air-conditioning systems, sprinkler risers and valves, or other fire detection, suppression or control elements shall be identified for the use of the fire department. Approved signs required to identify fire protection equipment and equipment location, shall be constructed of durable materials, permanently installed and readily visible. Action required- The room with the backflow valve to the hydrant shall be posted. Verified at inspection.
Duct smoke detectors
Resolved
05/12/2022

2018 IFC 907.3.1 Duct smoke detectors. Smoke detectors installed in ducts shall be listed for the air velocity, temperature and humidity present in the duct. Duct smoke detectors shall be connected to the building's fire alarm control unit when a fire alarm system is rquired by Section 907.2. Activation of a duct smoke detector shall initiate a visible and audible supervisory signal at a constantly attended location and shall perform the intended fire safety function in accordance with theis code and the International Mechanical Code. Duct smoke detectors shall not be used as a substitute for required open area detection. Action required- Provide remote annunciator/test/reset appliances for each RTU requiring duct detection. Verified at inspection.
Building Plan Review Approved with Conditions 05/17/2022 05/11/2022
Joe Frogge
Final Development Plan
Resolved
05/11/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes. 5/11/22 - acknowledged in letter
Misc
Resolved
05/11/2022

FDP and building permit not coordinated. Action required: Update domestic water design to match FDP. - Fire suppression sprinkler system? - (3) water services. - Water meters are to be exterior grade mounted.
Engineered truss package
Corrective Action Required
05/10/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Comment is for informational purposes. Per application truss package is deferred. Roof structure will not be inspected until after package is submitted and approved. (note - S200 roof framing plan does not show penetrations for HVAC and roof hatch.) 5/11/22 - acknowledged in letter
Miscellaneous Correction
Resolved
05/11/2022

Inadequate information. Action required: Provide footing designs for trash enclosure and monument sign. (A2 notes footings as per structural but not found in S-series drawings.)
Licensed Contractors Approved 05/17/2022 05/11/2022
Joe Frogge
LC - General Contractor
Resolved
05/11/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Provide an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Resolved
05/11/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Final Development Plan Review Approved 04/28/2022 04/28/2022
Scott Ready
Market Street Center building permit
Fire Plan Review Approved with Conditions 04/26/2022 04/25/2022
Jim Eden
Address numbers required
Corrective Action Required
04/25/2022

2018 IFC 505.1- Address numbers. New and existing buildings shall have approved address numbers, building numbers or approved building identification placed in a position that is plainly legible and visible from the street or road fronting the property. These numbers shall contrast with their background. In Multi-tenant commercial building where tenants have multiple entrances located on different sides of the building , each door shall be addressed. Address numbers shall be Arabic numerals or alphabet letters. Numbers shall be a minimum of 4 inches (102 mm) high with a minimum stroke width of 0.5 inch (12.7 mm). Action required-All doors shall be posted with suite/address number. Verified at inspection.
Knox box required
Corrective Action Required
04/25/2022

2018 IFC 506.1- Where required. Where access to or within a structure or an area is restricted because of secured openings or where immediate access is necessary for life-saving or fire-fighting purposes, the fire code official is authorized to require a key box to be installed in an approved location. The key box shall be of an approved type and shall contain keys to gain necessary access as required by the fire code official. Action required- Provide a Knox box at the water utility room. The backflow valve supplying the private hydrant shall be chained and locked in the open position with a key to the room and lock provided in the Knox Box.
Fire protection equipment identification
Corrective Action Required
04/25/2022

2018 IFC 510.1- Identification. Fire protection equipment shall be identified in an approved manner. Rooms containing controls for air-conditioning systems, sprinkler risers and valves, or other fire detection, suppression or control elements shall be identified for the use of the fire department. Approved signs required to identify fire protection equipment and equipment location, shall be constructed of durable materials, permanently installed and readily visible. Action required- The room with the backflow valve to the hydrant shall be posted.
Duct smoke detectors
Corrective Action Required
04/25/2022

2018 IFC 907.3.1 Duct smoke detectors. Smoke detectors installed in ducts shall be listed for the air velocity, temperature and humidity present in the duct. Duct smoke detectors shall be connected to the building's fire alarm control unit when a fire alarm system is rquired by Section 907.2. Activation of a duct smoke detector shall initiate a visible and audible supervisory signal at a constantly attended location and shall perform the intended fire safety function in accordance with theis code and the International Mechanical Code. Duct smoke detectors shall not be used as a substitute for required open area detection. Action required- Provide remote annunciator/test/reset appliances for each RTU requiring duct detection. Verified at inspection.
Building Plan Review Rejected 04/26/2022 04/14/2022
Joe Frogge
Final Development Plan
Corrective Action Required
04/14/2022

The building permit for this project cannot be issued until the Development Services Department has received, approved, and processed the Final Development Plan. Action required: Comment is for informational purposes.
Misc
Corrective Action Required
04/14/2022

FDP and building permit not coordinated. Action required: Update domestic water design to match FDP. - Fire suppression sprinkler system? - (3) water services. - Water meters are to be exterior grade mounted.
Engineered truss package
Corrective Action Required
04/14/2022

Copies of the engineered truss package were not provided at the time of permit application. Action required: Comment is for informational purposes. Per application truss package is deferred. Roof structure will not be inspected until after package is submitted and approved. (note - S200 roof framing plan does not show penetrations for HVAC and roof hatch.)
Miscellaneous Correction
Corrective Action Required
04/14/2022

Inadequate information. Action required: Provide footing designs for trash enclosure and monument sign. (A2 notes footings as per structural but not found in S-series drawings.)
Licensed Contractors Rejected 04/26/2022 04/14/2022
Joe Frogge
LC - General Contractor
Corrective Action Required
04/14/2022

Lee's Summit Code of Ordinance, Section7-130.10 - Business License. It shall be unlawful for any person to engage in the construction contracting business without first obtaining a business license as required under the applicable provisions of Chapter 28 of the Lee's Summit Code of Ordinances. Action required: Provide an email address & phone number for the on-site contact which is where inspection reports will be sent.
LC - MEP Subs
Corrective Action Required
04/14/2022

Lee's Summit Code of Ordinance, Section7-130.4 - Business License. (excerpt) No person, other than a licensed contractor or employees of a licensed contractor, shall engage in electrical, plumbing or mechanical business, construction, installation or maintenance unless duly licensed in accordance with this section. Action required: MEP subcontractors are required to be listed on permit. Provide company names of licensed MEP contractors.
Fees
Paid Fees Amount Paid Owing Date Paid
9110078-Valuation Fee for New Shell Building $4,700.00 $4,700.00 Paid 05/16/2022
91100C8-Sanitary Sewer Insp Fees $30.52 $30.52 Paid 05/11/2022
91100C9-Water Insp Fee $491.09 $491.09 Paid 05/11/2022
9110068-Storm Sewer Inspection Fee $2,242.75 $2,242.75 Paid 05/11/2022
9110081-Paved Surface Inspection Fee $5,538.57 $5,538.57 Paid 05/11/2022
9110071-Site Grading Fee $1,591.61 $1,591.61 Paid 05/11/2022
9110072-Water Test Fee $200.00 $200.00 Paid 05/11/2022
8331401-Water Tap Fee $29,250.00 $29,250.00 Paid 05/11/2022
8350015-Water Meter Fee $2,460.87 $2,460.87 Paid 05/11/2022
7232302-Commercial Excise Tax Fee $14,625.00 $14,625.00 Paid 08/05/2022
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Footing Inspection - Commercial Partial 6/16/2022 06/16/2022
Misc
Corrective Action Required
06/16/2022
- 6/16/22 PARTIAL GRID A.1 - 5.5
Foundation Inspection - Commercial Partial 6/21/2022 6/21/2022 06/21/2022
Misc
Corrective Action Required
06/21/2022
- 6/21/22 - PARTIAL STEM WALL INSPECTION AT GRID A.1 - 5.5
Footing Inspection - Commercial Partial 6/21/2022 (10:00) 6/21/2022 06/21/2022
Misc
Corrective Action Required
06/16/2022
- 6/16/22 PARTIAL GRID A.1 - 5.5 - 6/21/22 PARTIAL FOOTING, GRIDS A;4.5-7, 7;A-B, (2) COLUMN PADS AT 5;B, 6;B, UFER LOCATED AT GRID A;7
Electrical Service Inspection Failed 6/21/2022 6/21/2022 06/21/2022
Misc
Corrective Action Required
06/21/2022
UFER LOCATED AT FOOTING GRID A;7
Footing Inspection - Commercial Partial 6/23/2022 (2:30) 6/23/2022 06/23/2022
Misc
Corrective Action Required
06/21/2022
- 6/16/22 PARTIAL GRID A.1 - 5.5 - 6/21/22 PARTIAL FOOTING, GRIDS A;4.5-7, 7;A-B, (2) COLUMN PADS AT 5;B, 6;B, UFER LOCATED AT GRID A;7 - 6/22/22 PARTIAL FOOTING GRIDS LINE 1; A-C, LINE 4; A-C, LINE C; 1-2, (3) COLUMN PADS AT 4;B, 3;B, 2;B,
Foundation Inspection - Commercial Partial 6/23/2022 (2:30) 6/23/2022 06/23/2022
Misc
Corrective Action Required
06/21/2022
- 6/21/22 - PARTIAL STEM WALL INSPECTION AT GRID A.1 - 5.5
Footing Inspection - Commercial Partial 6/24/2022 (8:00) 6/24/2022 06/24/2022
Misc
Corrective Action Required
06/23/2022
- 6/16/22 PARTIAL GRID A.1 - 5.5 - 6/21/22 PARTIAL FOOTING, GRIDS A;4.5-7, 7;A-B, (2) COLUMN PADS AT 5;B, 6;B, UFER LOCATED AT GRID A;7 - 6/23/22 PARTIAL FOOTING GRIDS LINE 1; A-C, LINE 4; A-C, LINE C; 1-2, (3) COLUMN PADS AT 4;B, 3;B, 2;B, -6/24/22 PARTIAL FOOTING GRIDS LINE C; 1-4.5
Foundation Inspection - Commercial Partial 6/28/2022 6/28/2022 06/28/2022
Misc
Corrective Action Required
06/23/2022
- 6/21/22 - PARTIAL STEM WALL INSPECTION AT GRID A.1 - 5.5 - 6/28/22 - STEM WALL GRID 4.5; LINE A-C, GRID C; LINE 4.5-7, GRID C; LINES 4.5-4, GRID A; LINE 1-2
Underslab Electrical Inspection - Commercial Partial 6/29/2022 6/29/2022 06/29/2022
Misc
Corrective Action Required
06/29/2022

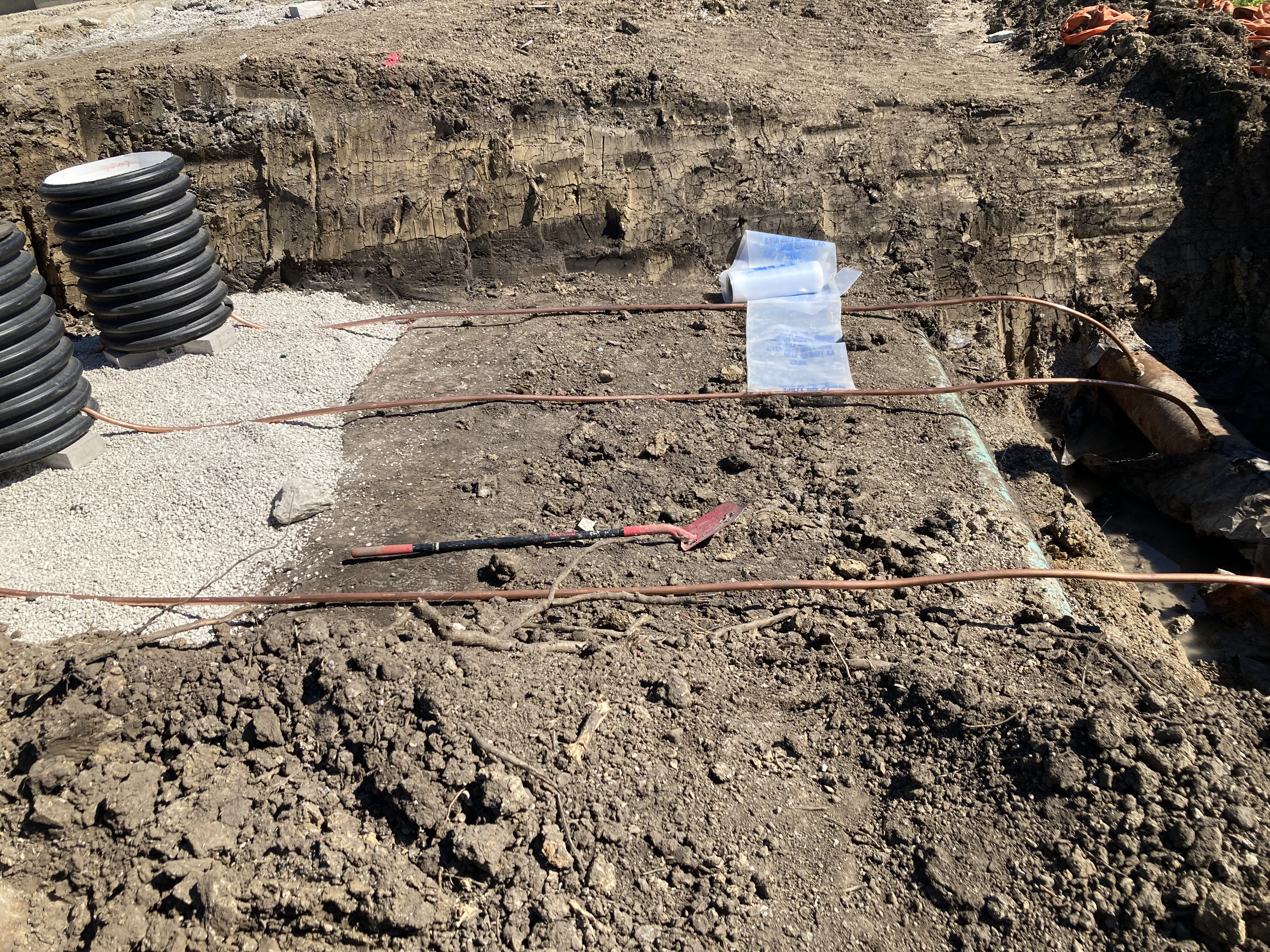

6/29/22 - UNDERGROUND CONDUIT GRID LINE A; 4.5-7
Underslab Plumbing Inspection - Commercial Partial 7/1/2022 7/1/2022 07/01/2022
Misc
Corrective Action Required
07/01/2022
7/1/22 - UNDERSLAB PLUMBING, STUB UP FOR NORTH SIDE TENANT GRID C;4.5, WASTE LINE ON SOUTH TENANT GRID C;LINES 4.5-7, GRID 7; C-A
Storm Sewer Construction Inspection Partial 7/18/2022 07/18/2022
Misc
Informational
07/18/2022
Working on line 2 and line 1, installing junction box 11, also installing pipe..
Fire Line Construction Inspection Partial 7/18/2022 07/18/2022
Misc
Informational
07/18/2022
Contractor asked for a water test shut so they can prepare for the tie in of the fire line. I sent a map to water utilities and they should be out in a few days.Steve Robbins 07/18/2022 11:28 AM
Sanitary Sewer Construction Inspection Partial 08/01/2022
Misc
Informational
08/01/2022
7.27.2022 Fleshman construction dug a shallow trench across Firestone’s driveway approach to make connection to public sanitary sewer . 7.29.2022 Fleshman backfilled pipe.
In-wall Inspection Partial 8/1/2022 8/1/2022 08/01/2022
Misc
Corrective Action Required
08/01/2022
8/1/22: PARTIAL INSPECTION OF FRAMING ALL (4) EXTERIOR WALLS AND PARTIAL INSTALL OF ZIP BOARD SHEATHING NAIL PATTERN OF EXTERIOR WALLS
Storm Sewer Construction Inspection Partial 8/2/2022 08/02/2022
Misc
Informational
07/18/2022
Working on line 2 and line 1, installing junction box 11, also installing pipe..
Misc
Informational
08/02/2022
The private storm appears to be completed. They need to install the lids on the boxes.Steve Robbins 08/02/2022 3:58 PM
In-wall Inspection Partial 8/8/2022 8/8/2022 08/08/2022
Misc
Corrective Action Required
08/01/2022
8/1/22: PARTIAL INSPECTION OF FRAMING ALL (4) EXTERIOR WALLS AND PARTIAL INSTALL OF ZIP BOARD SHEATHING NAIL PATTERN OF EXTERIOR WALLS, ROOF 8/8/22: COMPLETION ZIP BOARD INSTALL NAIL PATTERN, TRUSS H2.5 CLIPS INSTALLED
Fire Line Construction Inspection Partial 08/18/2022
Misc
Informational
07/18/2022
Contractor asked for a water test shut so they can prepare for the tie in of the fire line. I sent a map to water utilities and they should be out in a few days.Steve Robbins 07/18/2022 11:28 AM 7-18-22 RH. Fire line was tied in. 16’ of pipe was placed between building and tie into the 12” main. Valves were placed on all sides of the T. Dry blocks were placed once tie in was complete until concrete could be poured. Everything was connected and turned on once complete.
Fire Line Construction Inspection Partial 08/18/2022
Misc
Informational
08/18/2022
Contractor asked for a water test shut so they can prepare for the tie in of the fire line. I sent a map to water utilities and they should be out in a few days.Steve Robbins 07/18/2022 11:28 AM 7-18-22 RH. Fire line was tied in. 16’ of pipe was placed between building and tie into the 12” main. Valves were placed on all sides of the T. Dry blocks were placed once tie in was complete until concrete could be poured. Everything was connected and turned on once complete. 7-18-22 RH. Thrust blocks were poured for fire line tie in.
Fire Line - Hydrostatic Test Partial 08/19/2022
Misc
Informational
08/19/2022
8-19-22 RH. Contractor flushed the fire line. Planned hydrostatic test at 10am.
Fire Line - Hydrostatic Test Partial 08/22/2022
Misc
Informational
08/19/2022
8-19-22 RH. Contractor flushed the fire line. Planned hydrostatic test at 10am. 8-22 RH. Hydrostatic test started 7:49am. Pressure was put at 200psi and held at the start.
Erosion Control Inspection Residential Partial 08/22/2022
Misc
Informational
08/22/2022
8-22-22 RH. Erosion control is up and in working order.
Fire Line - Hydrostatic Test Passed 08/22/2022
Misc
Informational
08/22/2022
8-19-22 RH. Contractor flushed the fire line. Planned hydrostatic test at 10am. 8-22 RH. Hydrostatic test started 7:49am. Pressure was put at 200psi and held at the start. 8-22 RH. Hydrostatic test passed holding the 200 psi pressure for 2 hours.
Site Visit Partial 08/24/2022
Misc
Informational
07/15/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Contractor continues to clean up site around detentions area. Sanitary will be test on Friday at 10am.
Piers/Caissons Inspection - Commercial Partial 8/26/2022 (10:00) 8/26/2022 08/26/2022
Misc
Corrective Action Required
08/26/2022
8/26/22 - INSPECTED (8) LIGHT POLE BASES AT WEST SIDE OF BUILDING
Site Visit Partial 09/01/2022
Misc
Informational
08/24/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area.
Sanitary Sewer - Mandrel Partial 09/02/2022
Misc
Informational
09/02/2022
9-2-22 RH. The 7.37” mandrel was pulled through 8” sanitary line from MH A-1 to the exciting Sanitary MH that it was connected too. Mandrel passed.
Sanitary Sewer - Vacuum Partial 09/02/2022
Misc
Informational
09/02/2022
9-2-22 RH. MH A-1 held the 10psi of pressure for vacuum for the 2 minutes needed for the manhole. Vacuum passed for MH A-1.
Sanitary Sewer - Air Test Partial 09/02/2022
Misc
Informational
09/02/2022
9-2-22 RH. Line between New MH A-1 and Exciting MH was pressured and held 4.0 psig for the 7:34 time limit with no drop. Line passed pressure test.
Erosion Control Inspection Residential Partial 09/06/2022
Misc
Informational
09/06/2022
9-6-22 RH. Erosion control is up and in working order.
Site Visit Partial 09/06/2022
Misc
Informational
09/01/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today.
Sanitary Sewer Construction Inspection Partial 9/7/2022 9/7/2022 09/07/2022
Misc
Informational
08/01/2022
7.27.2022 Fleshman construction dug a shallow trench across Firestone’s driveway approach to make connection to public sanitary sewer . 7.29.2022 Fleshman backfilled pipe. 9-2-22 RH. Fleshman had all connections made from sanitary connection to grinder pump and building.
Water Service Inspection Partial 9/7/2022 9/7/2022 09/07/2022
Misc
Informational
09/07/2022
9-2-22 RH. 2 water connections and irrigation were connected to main with copper going in and out of valves to the building.
Water Service Inspection Passed 9/7/2022 9/7/2022 09/07/2022
Misc
Informational
09/07/2022
9-2-22 RH. 2 water connections and irrigation were connected to main with copper going in and out of valves to the building. 9-7-22 5' CONNECTION FROM LINE TO BUILDING ENTRY
Sanitary Sewer Construction Inspection Passed 9/7/2022 9/7/2022 09/07/2022
Misc
Informational
09/07/2022
7.27.2022 Fleshman construction dug a shallow trench across Firestone’s driveway approach to make connection to public sanitary sewer . 7.29.2022 Fleshman backfilled pipe. 9-2-22 RH. Fleshman had all connections made from sanitary connection to grinder pump and building. 9-7-22 5' CONNECTION FROM SANITARY LINE TO BUILDING INTERIOR
Site Visit Partial 09/07/2022
Misc
Informational
09/06/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today.
Erosion Control Inspection Residential Partial 09/12/2022
Misc
Informational
09/06/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order.
Site Visit Partial 09/12/2022
Misc
Informational
09/07/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today. 9-12-22 RH. No work for development since 9-7-22.
Site Visit Partial 09/13/2022
Misc
Informational
09/12/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today. 9-12-22 RH. No work for development since 9-7-22. 9-13-22 RH. No work for development today.
Site Visit Partial 09/15/2022
Misc
Informational
09/13/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today. 9-12-22 RH. No work for development since 9-7-22. 9-13-22 RH. No work for development today. 9-15-22 RH. No work for development since 9-13-22.
Underground Electrical Inspection - Commercial Partial 9/15/2022 9/15/2022 09/15/2022
Misc
Informational
09/15/2022
9/15/22 - PARTIAL INSPECTION OF UNDERGROUND CONDUIT FOR (7) LIGHT POLE BASES AT WEST SIDE PARKING LOT
Sanitary Sewer - Air Test Passed 09/15/2022
Misc
Informational
09/02/2022
9-2-22 RH. Line between New MH A-1 and Exciting MH was pressured and held 4.0 psig for the 7:34 time limit with no drop. Line passed pressure test.
Sanitary Sewer - Mandrel Passed 09/15/2022
Misc
Informational
09/02/2022
9-2-22 RH. The 7.37” mandrel was pulled through 8” sanitary line from MH A-1 to the exciting Sanitary MH that it was connected too. Mandrel passed.
Sanitary Sewer - Vacuum Passed 09/15/2022
Misc
Informational
09/02/2022
9-2-22 RH. MH A-1 held the 10psi of pressure for vacuum for the 2 minutes needed for the manhole. Vacuum passed for MH A-1.
Sanitary Sewer - Camera Test Passed 10/7/2022 09/15/2022
Misc
Informational
09/15/2022
9-15-22 RH. City of LS completed the camera test and passed the sanitary line.
Fire Line Construction Inspection Passed 09/15/2022
Misc
Informational
08/18/2022
Contractor asked for a water test shut so they can prepare for the tie in of the fire line. I sent a map to water utilities and they should be out in a few days.Steve Robbins 07/18/2022 11:28 AM 7-18-22 RH. Fire line was tied in. 16’ of pipe was placed between building and tie into the 12” main. Valves were placed on all sides of the T. Dry blocks were placed once tie in was complete until concrete could be poured. Everything was connected and turned on once complete. 7-18-22 RH. Thrust blocks were poured for fire line tie in.
Pavement-Aggregate Base Partial 09/16/2022
Misc
Informational
09/16/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm.
Underground Electrical Inspection - Commercial Partial 9/16/2022 09/16/2022
Misc
Informational
09/15/2022
9/15/22 - PARTIAL INSPECTION OF UNDERGROUND CONDUIT FOR (7) LIGHT POLE BASES AT WEST SIDE PARKING LOT 9/16/22- PARTIAL INSPECTION OF UNDERGROUND CONDUIT FOR (1) LIGHT POLE BASE AND HOME RUN TO BUILDING AT WEST SIDE OF BUILDING PARKING LOT
Pavement-Aggregate Base Partial 09/20/2022
Misc
Informational
09/16/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm. 9-19-22 RH. Soil subgrade was proof rolled with a dump truck holding 25 tons of aggregate. Proof roll for soil subgrade die not rut or pump. Aggregate and geo grid will start being placed tomorrow.
Pavement-Aggregate Base Partial 09/20/2022
Misc
Informational
09/20/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm. 9-19-22 RH. Soil subgrade was proof rolled with a dump truck holding 25 tons of aggregate. Proof roll for soil subgrade die not rut or pump. Aggregate and geo grid will start being placed tomorrow. 9-20-22 RH. Geogrid was placed on the soil sub grade. Geogrid meets spec and was placed correctly before aggregate was placed.
Curb - Proof Roll Partial 09/21/2022
Misc
Informational
09/21/2022
9-21-22. Curb was proofrolled with a 25 ton weighted down dump truck. Proofroll passed inspection for curb to be poured.
Pavement-Aggregate Base Partial 09/21/2022
Misc
Informational
09/20/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm. 9-19-22 RH. Soil subgrade was proof rolled with a dump truck holding 25 tons of aggregate. Proof roll for soil subgrade die not rut or pump. Aggregate and geo grid will start being placed tomorrow. 9-20-22 RH. Geogrid was placed on the soil sub grade. Geogrid meets spec and was placed correctly before aggregate was placed. 9-21-22 RH. Aggregate base was placed today and rolled with a flat drum roller.
Pavement-Curb Construction Partial 09/21/2022
Misc
Informational
09/21/2022
9-21-22 RH. Curb started being installed on site today.
Pavement-Curb Construction Partial 09/22/2022
Misc
Informational
09/21/2022
9-21-22 RH. Curb started being installed on site today. 9-22-22 RH. Curb continued to be poured in parking lot.
Site Visit Partial 09/23/2022
Misc
Informational
09/15/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today. 9-12-22 RH. No work for development since 9-7-22. 9-13-22 RH. No work for development today. 9-15-22 RH. No work for development since 9-13-22. 9-23-22 RH. No work on site today due to rain.
Curb - Proof Roll Passed 09/26/2022
Misc
Informational
09/21/2022
9-21-22. Curb was proofrolled with a 25 ton weighted down dump truck. Proofroll passed inspection for curb to be poured.
Pavement-Curb Construction Partial 09/26/2022
Misc
Informational
09/22/2022
9-21-22 RH. Curb started being installed on site today. 9-22-22 RH. Curb continued to be poured in parking lot. 9-23-22 RH. Curb construction was completed today.
Pavement-Curb Construction Passed 09/26/2022
Misc
Informational
09/26/2022
9-21-22 RH. Curb started being installed on site today. 9-22-22 RH. Curb continued to be poured in parking lot. 9-23-22 RH. Curb construction was completed today.
Erosion Control Inspection Residential Partial 09/26/2022
Misc
Informational
09/12/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order.
Pavement-Aggregate Base Partial 09/26/2022
Misc
Informational
09/21/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm. 9-19-22 RH. Soil subgrade was proof rolled with a dump truck holding 25 tons of aggregate. Proof roll for soil subgrade die not rut or pump. Aggregate and geo grid will start being placed tomorrow. 9-20-22 RH. Geogrid was placed on the soil sub grade. Geogrid meets spec and was placed correctly before aggregate was placed. 9-21-22 RH. Aggregate base was placed today and rolled with a flat drum roller. 9-26-22 RH. Aggregate was placed for entire parking lot.
Pavement-Proof Roll Partial 09/27/2022
Misc
Informational
09/27/2022
9-27-22 RH. Proof roll was completed for one of the approaches to the job site. Grading was still be completed for rest of parking lot and other approach.
Pavement-Proof Roll Partial 09/30/2022
Misc
Informational
09/27/2022
9-27-22 RH. Proof roll was completed for one of the approaches to the job site. Grading was still be completed for rest of parking lot and other approach. 9-30-33 RH. Proof roll was completed on the other approach on site. Proof roll passed with 22 tons on the truck.
Erosion Control Inspection Residential Partial 10/03/2022
Misc
Informational
09/26/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order.
Rated Assembly Inspection Failed 10/3/2022 10/3/2022 10/03/2022
Misc
Corrective Action Required
10/03/2022
SUBMIT REVISED PLANS FOR APPROVAL THAT INCLUDE UL DESIGN OF RATED DEMISING WALL, TBD ON DESIGN UNTIL UL DESIGN IS APPROVED, SCREW PATTERN CURRENTLY 12" OC, SOLID BLOCK BETWEEN STUDS AT BOTTOM EDGE TO ALLOW FOR EDGE SCREWS, FIRE CAULK PENETRATIONS AT FIREWALL, STENCIL AND IDENTIFY RATING ON WALL ABOVE CEILING PER IBC 703.7
Sidewalk Inspection Partial 10/6/2022 10/6/2022 10/06/2022
Misc
Informational
10/06/2022
10-6-22 RH. Public sidewalk between Firestone and jobsite was formed up and aggregate was placed and compacted. Pour scheduled for Monday.
Sidewalk Inspection Partial 10/10/2022 10/10/2022 10/07/2022
Misc
Informational
10/06/2022
10-6-22 RH. Public sidewalk between Firestone and jobsite was formed up and aggregate was placed and compacted. Pour scheduled for Monday. 10-7-22 RH. Public sidewalk switchback was inspected and found it to be formed up correctly and aggregate was placed and compacted.
Pavement-Proof Roll Passed 10/10/2022
Misc
Informational
09/30/2022
9-27-22 RH. Proof roll was completed for one of the approaches to the job site. Grading was still be completed for rest of parking lot and other approach. 9-30-33 RH. Proof roll was completed on the other approach on site. Proof roll passed with 22 tons on the truck. 10-10-22 RH. Proof roll was completed for the drive and parking spaces. This is all passed with 21 tons on the truck.
Erosion Control Inspection Residential Partial 10/11/2022
Misc
Informational
10/03/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order. 10-11-22 RH. Erosion control is up and in working order.
Site Visit Partial 10/11/2022
Misc
Informational
09/23/2022
On 7.15.2022 inspected the storm sewer Fleshman Construction using 48-inch HDPE with City approved connections and head wall installed. DJ 8-24-22 RH. No work for development today. 8-31-22 RH. Site continues to be cleaned up around detention area. 9-1-22. RH. Site continues to be graded and filled around detention area. 9-6-22 RH. No work for development today. 9-7-22 RH. No work for development today. 9-12-22 RH. No work for development since 9-7-22. 9-13-22 RH. No work for development today. 9-15-22 RH. No work for development since 9-13-22. 9-23-22 RH. No work on site today due to rain. 10-11-22 RH. No work on site today due to rain. Asphalt will be pushed to tomorrow due to rain.
Pavement-Aggregate Base Passed 10/13/2022
Misc
Informational
09/26/2022
9-16-22 RH. Aggregate started to be delivered on site for future pavement. Proof roll is scheduled for Monday at 2pm. 9-19-22 RH. Soil subgrade was proof rolled with a dump truck holding 25 tons of aggregate. Proof roll for soil subgrade die not rut or pump. Aggregate and geo grid will start being placed tomorrow. 9-20-22 RH. Geogrid was placed on the soil sub grade. Geogrid meets spec and was placed correctly before aggregate was placed. 9-21-22 RH. Aggregate base was placed today and rolled with a flat drum roller. 9-26-22 RH. Aggregate was placed for entire parking lot.
Pavement-Surface Partial 10/13/2022
Misc
Informational
10/13/2022
10-13-22 RH. Asphalt base started to be placed today when temperature was 51 degrees and rising. 1 lift of 4” base mix was placed with correct temperatures and rolling method. On site testing was completed with passing results. Surface asphalt will be placed tomorrow.
Rated Assembly Inspection Partial 10/14/2022 10/14/2022 10/14/2022
Misc
Corrective Action Required
10/03/2022
FIRE CAULK PENETRATIONS AT FIREWALL STENCIL AND IDENTIFY RATING ON WALL ABOVE CEILING PER IBC 703.7 ON SOUTH SIDE TENANT OK TO MUD AND TAPE
Erosion Control Inspection Residential Partial 10/17/2022
Misc
Informational
10/11/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-17-22 RH. Erosion control is up and in working order.
Storm Sewer Construction Inspection Passed 10/17/2022
Misc
Informational
08/02/2022
Working on line 2 and line 1, installing junction box 11, also installing pipe..
Misc
Informational
08/02/2022
The private storm appears to be completed. They need to install the lids on the boxes.Steve Robbins 08/02/2022 3:58 PM
Pavement-Surface Partial 10/17/2022
Misc
Informational
10/13/2022
10-13-22 RH. Asphalt base started to be placed today when temperature was 51 degrees and rising. 1 lift of 4” base mix was placed with correct temperatures and rolling method. On site testing was completed with passing results. Surface asphalt will be placed tomorrow. 10-14-22 RH. Surface was placed for parking lot today while temperatures were in compliance. 10-17-22 RH. Surface pavement is completely installed and are just waiting on stripping to occur.
Pavement-Surface Passed 10/18/2022
Misc
Informational
10/17/2022
10-13-22 RH. Asphalt base started to be placed today when temperature was 51 degrees and rising. 1 lift of 4” base mix was placed with correct temperatures and rolling method. On site testing was completed with passing results. Surface asphalt will be placed tomorrow. 10-14-22 RH. Surface was placed for parking lot today while temperatures were in compliance. 10-17-22 RH. Surface pavement is completely installed and are just waiting on stripping to occur.
Sidewalk Inspection Partial 10/24/2022 10/24/2022 10/19/2022
Misc
Informational
10/07/2022
10-6-22 RH. Public sidewalk between Firestone and jobsite was formed up and aggregate was placed and compacted. Pour scheduled for Monday. 10-7-22 RH. Public sidewalk switchback was inspected and found it to be formed up correctly and aggregate was placed and compacted. 10-19-22 RH. Contractor poured concrete today for sidewalk.
Rated Assembly Inspection Passed 10/20/2022 10/20/2022 10/20/2022
Misc
Resolved
10/20/2022
FIRE CAULK PENETRATIONS AT FIREWALL STENCIL AND IDENTIFY RATING ON WALL ABOVE CEILING PER IBC 703.7 ON SOUTH SIDE TENANT OK TO MUD AND TAPE
Electrical Service Inspection Passed 10/20/2022 10/20/2022 10/20/2022
Misc
Resolved
10/20/2022
UFER LOCATED AT FOOTING GRID A;7
Sidewalk Inspection Passed 10/24/2022 10/24/2022
Misc
Informational
10/19/2022
10-6-22 RH. Public sidewalk between Firestone and jobsite was formed up and aggregate was placed and compacted. Pour scheduled for Monday. 10-7-22 RH. Public sidewalk switchback was inspected and found it to be formed up correctly and aggregate was placed and compacted. 10-19-22 RH. Contractor poured concrete today for sidewalk. 10-24-22 RH. Sidewalk meets LS and ADA specification.
Erosion Control Inspection Residential Partial 10/24/2022
Misc
Informational
10/17/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-17-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 10-31-22 RH. Erosion control is up and in working order.
Gas Service Inspection - Commercial Failed 10/25/2022 10/25/2022 10/25/2022
Misc
Corrective Action Required
10/25/2022
BOND GAS LINE TO BUILDING GROUNDING ELECTRODE SYSTEM
Gas Service Inspection - Commercial Passed 10/31/2022 10/31/2022 10/31/2022
Misc
Resolved
10/31/2022
Erosion Control Inspection Residential Partial 11/01/2022
Misc
Informational
10/24/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-17-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 11-1-22 RH.Erosion control is in place. Plants started to be placed on jobsite. Sod will be coming soon.
Erosion Control Inspection Residential Partial 11/04/2022
Misc
Informational
11/01/2022
8-22-22 RH. Erosion control is up and in working order. 9-12-22 RH. Erosion control is up and in working order. 9-26-22 RH. Erosion control is up and in working order. 10-3-22 RH. Erosion control is up and in working order. 10-11-22 RH. Erosion control is up and in working order. 10-17-22 RH. Erosion control is up and in working order. 10-24-22 RH. Erosion control is up and in working order. 11-1-22 RH.Erosion control is in place. Plants started to be placed on jobsite. Sod will be coming soon. 11-4-22 RH. Vegetation was put all around jobsite with sod and plants being put into place.
Above Ceiling Inspection Passed 1/3/2023 01/03/2023
Footing Inspection - Commercial Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
- 6/16/22 PARTIAL GRID A.1 - 5.5 - 6/21/22 PARTIAL FOOTING, GRIDS A;4.5-7, 7;A-B, (2) COLUMN PADS AT 5;B, 6;B, UFER LOCATED AT GRID A;7 - 6/23/22 PARTIAL FOOTING GRIDS LINE 1; A-C, LINE 4; A-C, LINE C; 1-2, (3) COLUMN PADS AT 4;B, 3;B, 2;B, -6/24/22 PARTIAL FOOTING GRIDS LINE C; 1-4.5
Foundation Inspection - Commercial Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
- 6/21/22 - PARTIAL STEM WALL INSPECTION AT GRID A.1 - 5.5 - 6/28/22 - STEM WALL GRID 4.5; LINE A-C, GRID C; LINE 4.5-7, GRID C; LINES 4.5-4, GRID A; LINE 1-2
Underslab Electrical Inspection - Commercial Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
6/29/22 - UNDERGROUND CONDUIT GRID LINE A; 4.5-7
Underslab Plumbing Inspection - Commercial Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
7/1/22 - UNDERSLAB PLUMBING, STUB UP FOR NORTH SIDE TENANT GRID C;4.5, WASTE LINE ON SOUTH TENANT GRID C;LINES 4.5-7, GRID 7; C-A
In-wall Inspection Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
8/1/22: PARTIAL INSPECTION OF FRAMING ALL (4) EXTERIOR WALLS AND PARTIAL INSTALL OF ZIP BOARD SHEATHING NAIL PATTERN OF EXTERIOR WALLS, ROOF 8/8/22: COMPLETION ZIP BOARD INSTALL NAIL PATTERN, TRUSS H2.5 CLIPS INSTALLED
Piers/Caissons Inspection - Commercial Passed 9/15/2022 (2:00) 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
8/26/22 - INSPECTED (8) LIGHT POLE BASES AT WEST SIDE OF BUILDING
Underground Electrical Inspection - Commercial Passed 1/3/2023 01/03/2023
Misc
Resolved
01/03/2023
9/15/22 - PARTIAL INSPECTION OF UNDERGROUND CONDUIT FOR (7) LIGHT POLE BASES AT WEST SIDE PARKING LOT 9/16/22- PARTIAL INSPECTION OF UNDERGROUND CONDUIT FOR (1) LIGHT POLE BASE AND HOME RUN TO BUILDING AT WEST SIDE OF BUILDING PARKING LOT
Occupancy Inspection - Engineering Temporary C of O 1/4/2023 01/04/2023
Misc
Informational
01/04/2023
TCO is Good. Neededd for Final Occupancy 1. Remove trash bin and make sure all debris is cleaned up.
Final Inspection - Commercial Failed 1/4/2023 01/04/2023
Misc
Corrective Action Required
01/04/2023
-Upload third party inspection report to permit -Permanent address labels on disconnects and meter cans -GFCI protections at outlets in mechanical room -Provide schedule for all breaker locations at house panel -Secure MC at mech room -Label all RTU units on roof ***SEE FIRE, PLANNING, WATER AND ENGINEERING GROUP INSPECTION REPORTS FOR THOSE DEPT CORRECTIONS
Occupancy Inspection - Planning Temporary C of O 1/4/2023 01/04/2023
Corrective Action Required
01/04/2023
All exterior trash enclosure gates must be constructed of a solid steel opaque gate painted to be compatible with the color of the masonry or steel walls and building it is to serve or a steel framed semi-opaque gate with a screen mesh material
Corrective Action Required
01/04/2023
Wall-mounted lights shall utilize full cut-off fixtures. The wall lights on the sides and rear of the building must be replaced with lights with full cut-off fixtures.
Occupancy Inspection - Water Utilities Passed 01/24/2023
Occupancy Inspection - Fire Failed 1/4/2023 1/4/2023 02/14/2023
Occupancy Inspection - Engineering Passed 02/17/2023
Misc
Informational
01/04/2023
TCO is Good. Neededd for Final Occupancy 1. Remove trash bin and make sure all debris is cleaned up. Passed for engineering storage containters and trash bins do not belong to builder.
Occupancy Inspection - Planning Passed 02/17/2023
Final Inspection - Commercial Passed 2/17/2023 02/17/2023
Misc
Resolved
02/17/2023
***SEE FIRE, PLANNING, WATER AND ENGINEERING GROUP INSPECTION REPORTS FOR THOSE DEPT CORRECTIONS
Final Inspection - Commercial Passed 02/17/2023
Occupancy Inspection - Fire Passed 2/17/2023 02/21/2023
Documents & Images
Date Uploaded File Type Document Name
04/12/2022 Application Form 2022.04.12 Commerical Bldg Permit App
04/12/2022 Plans 2022_04_12 Building Plans Permit Set (v1)
04/12/2022 Engineer Report/Study 2022_04_12 Structural Calcs (v1)
04/25/2022 Letter DS P/R Corrections Document
04/27/2022 Letter Fire Building Plan Review
05/05/2022 Letter 2022_05_05 Applicant Reponse to Comments
05/05/2022 Plans 2022_05_05 Building Plans Permit Set (v2_1)
05/11/2022 Receipt Receipt for transaction:2022-003299
05/13/2022 Approved Plans FDP Approved Set 042822_2022-04-27 Market Street Center - FDP
05/13/2022 Approved Plans approved Building Plans Permit Set (v2_1)
05/16/2022 Receipt Receipt for transaction: 2022-003472
05/16/2022 Letter DS Building Permit
06/01/2022 Letter Fire Building Plan Review
06/16/2022 Letter INSPECTION SUMMARY
06/17/2022 Plans 2022.06.13 Engineer Stamped Approved Truss Shop Drawings (3501 SW Market St)
06/21/2022 Letter INSPECTION SUMMARY
06/21/2022 Letter INSPECTION SUMMARY
06/21/2022 Letter INSPECTION SUMMARY
06/23/2022 Approved Plans approved trusses
06/23/2022 Letter INSPECTION SUMMARY
06/23/2022 Letter INSPECTION SUMMARY
06/24/2022 Letter INSPECTION SUMMARY
06/28/2022 Letter INSPECTION SUMMARY
06/29/2022 Letter INSPECTION SUMMARY
07/01/2022 Letter INSPECTION SUMMARY
07/18/2022 Letter INSPECTION SUMMARY
07/18/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter INSPECTION SUMMARY
07/21/2022 Letter INSPECTION SUMMARY
08/01/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter INSPECTION SUMMARY
08/02/2022 Letter Inspection Summary
08/05/2022 Receipt Receipt for transaction:2022-006432
08/08/2022 Letter INSPECTION SUMMARY
08/18/2022 Letter INSPECTION SUMMARY

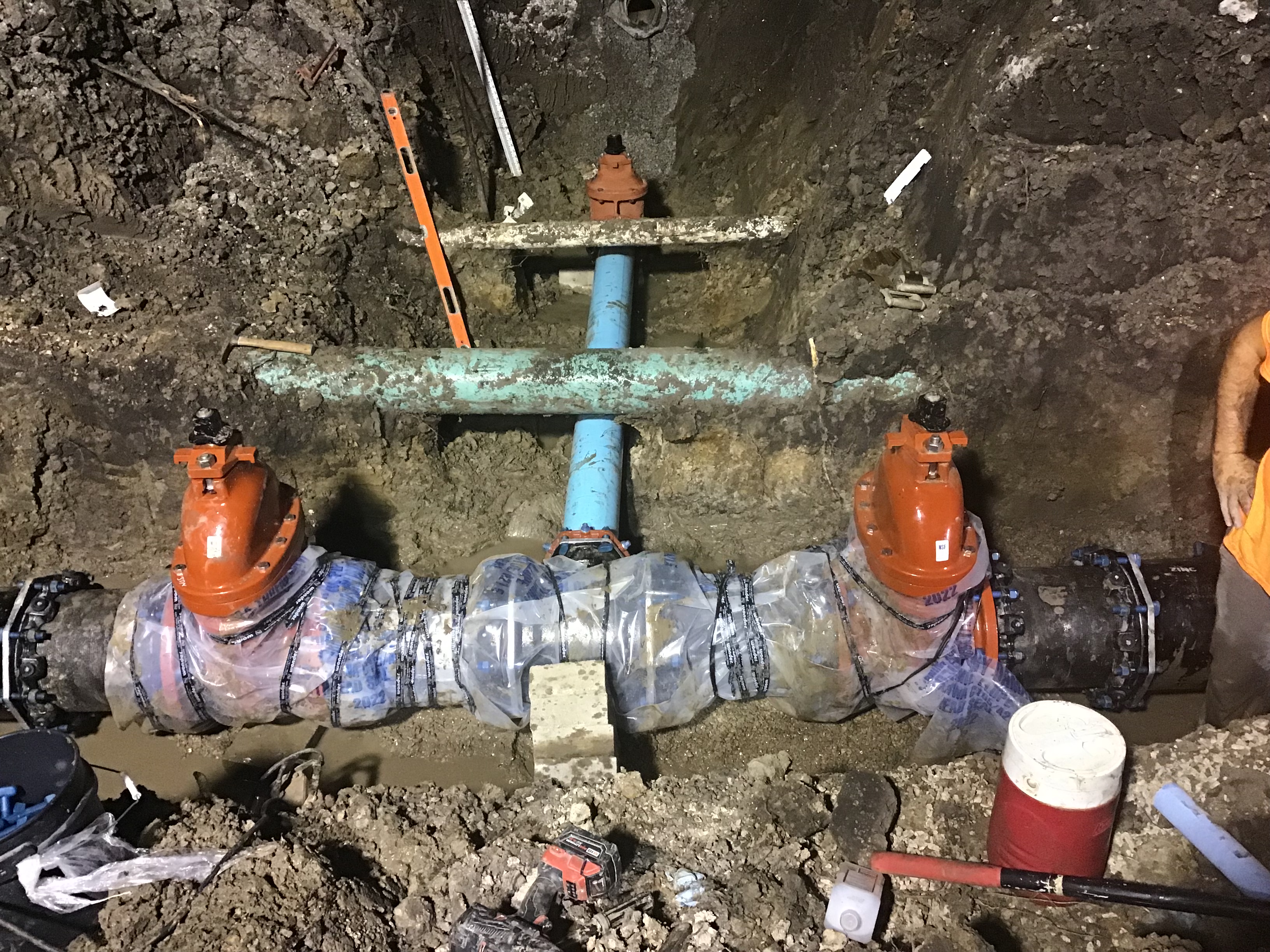

08/18/2022 8-18-22 Fire Tie In

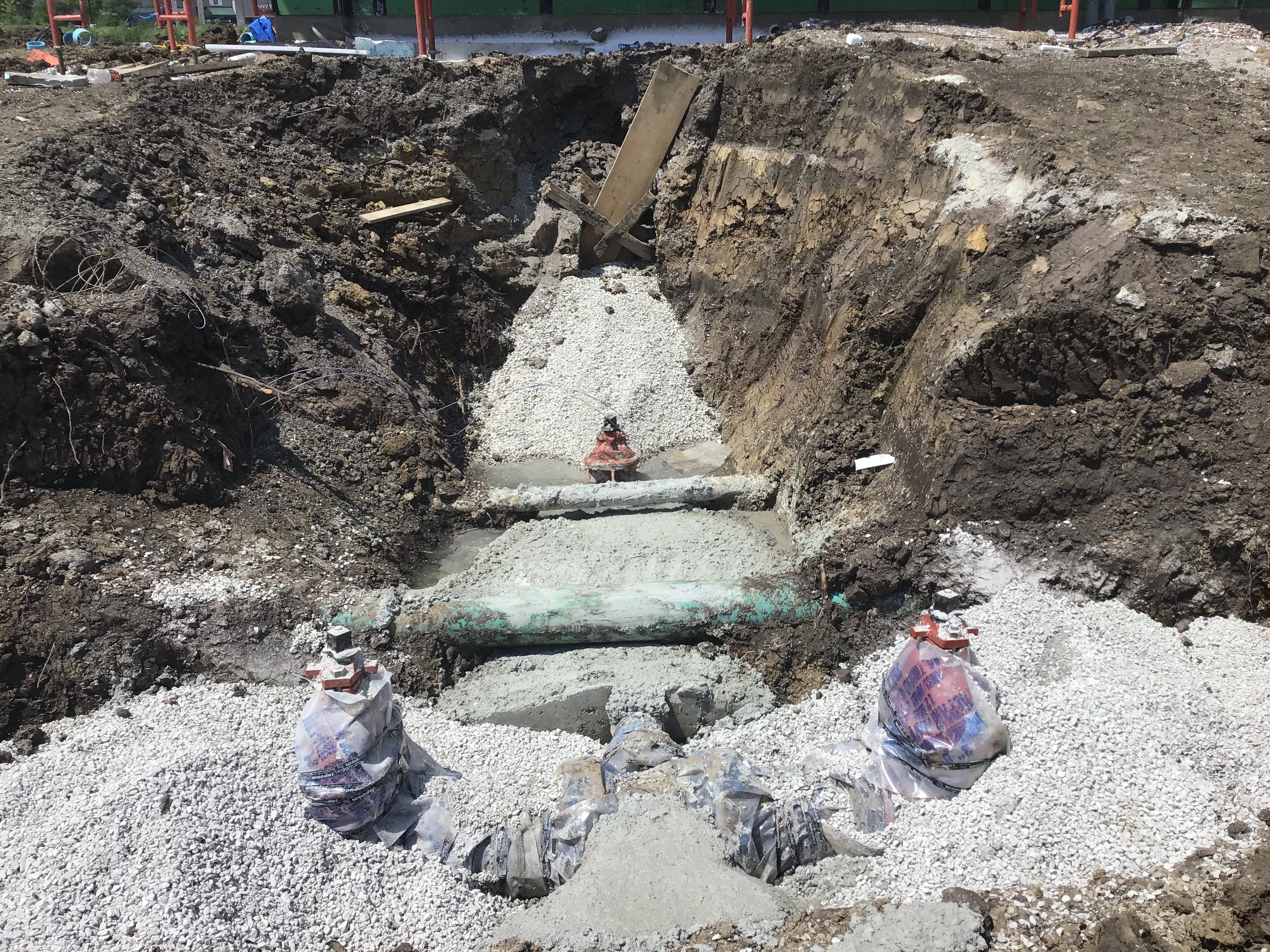

08/18/2022 7-18-22 Poured thrust Block
08/18/2022 Letter INSPECTION SUMMARY
08/19/2022 Letter INSPECTION SUMMARY
08/22/2022 Letter INSPECTION SUMMARY
08/22/2022 49am
08/22/2022 Letter INSPECTION SUMMARY

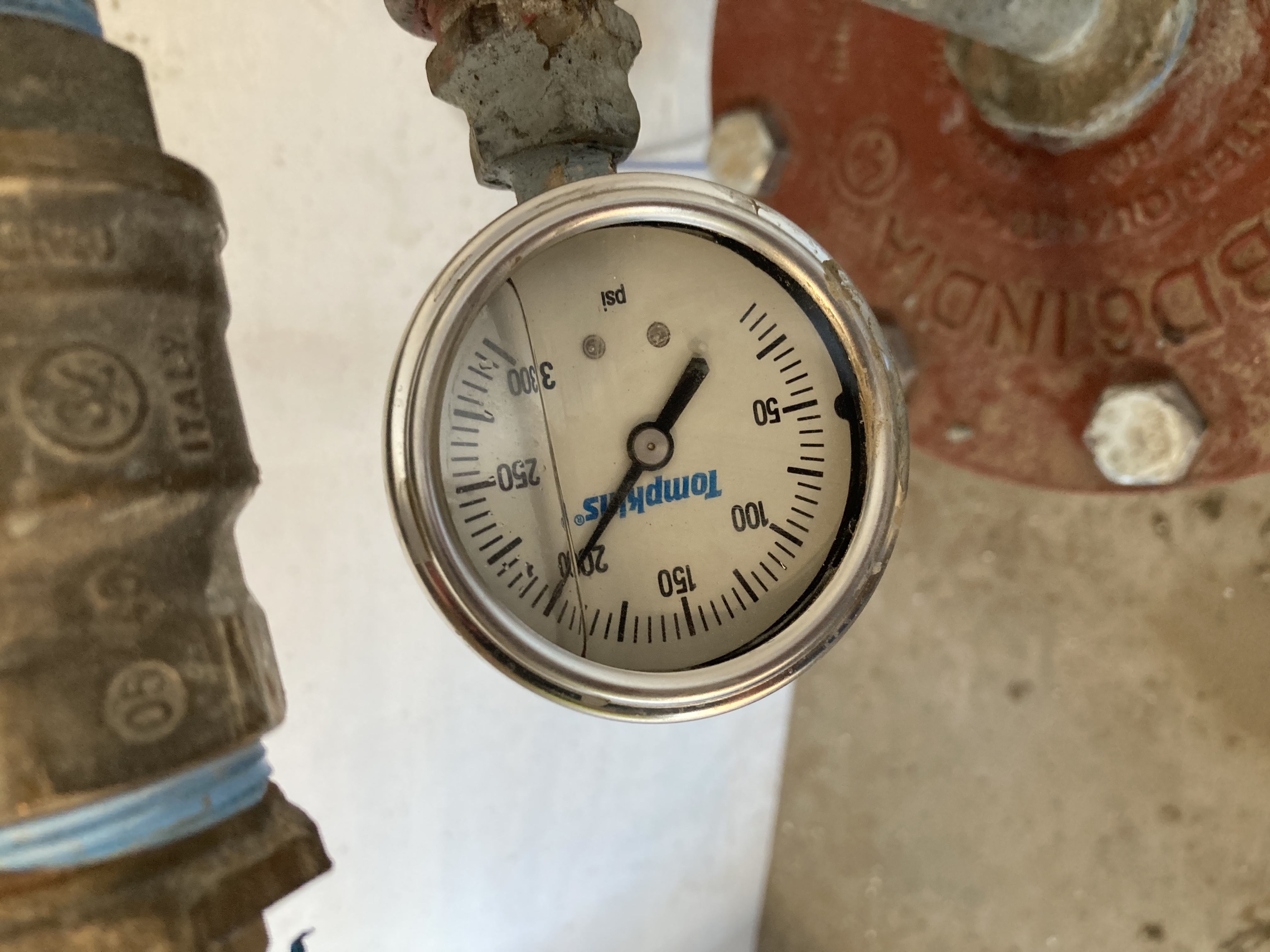

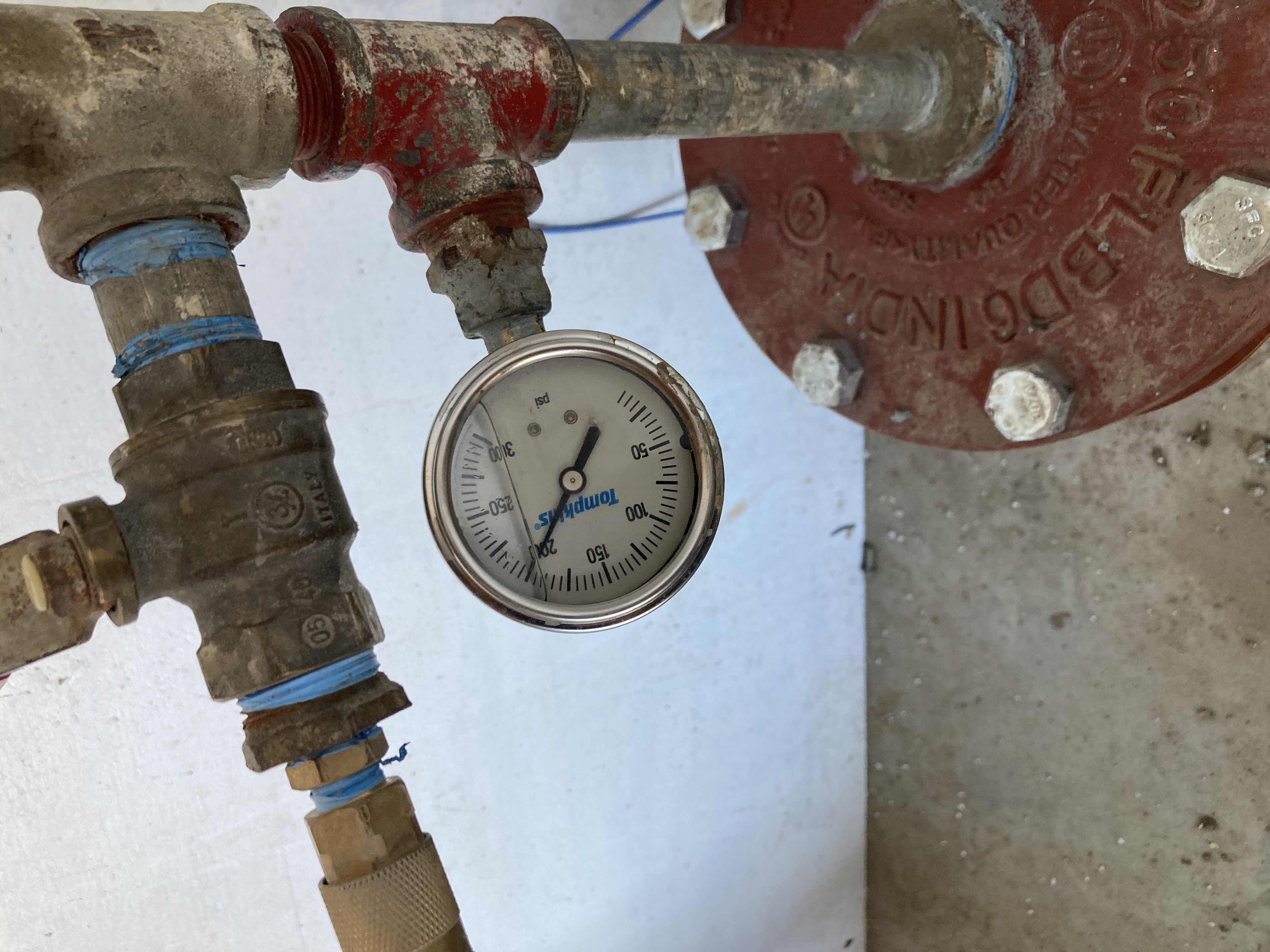

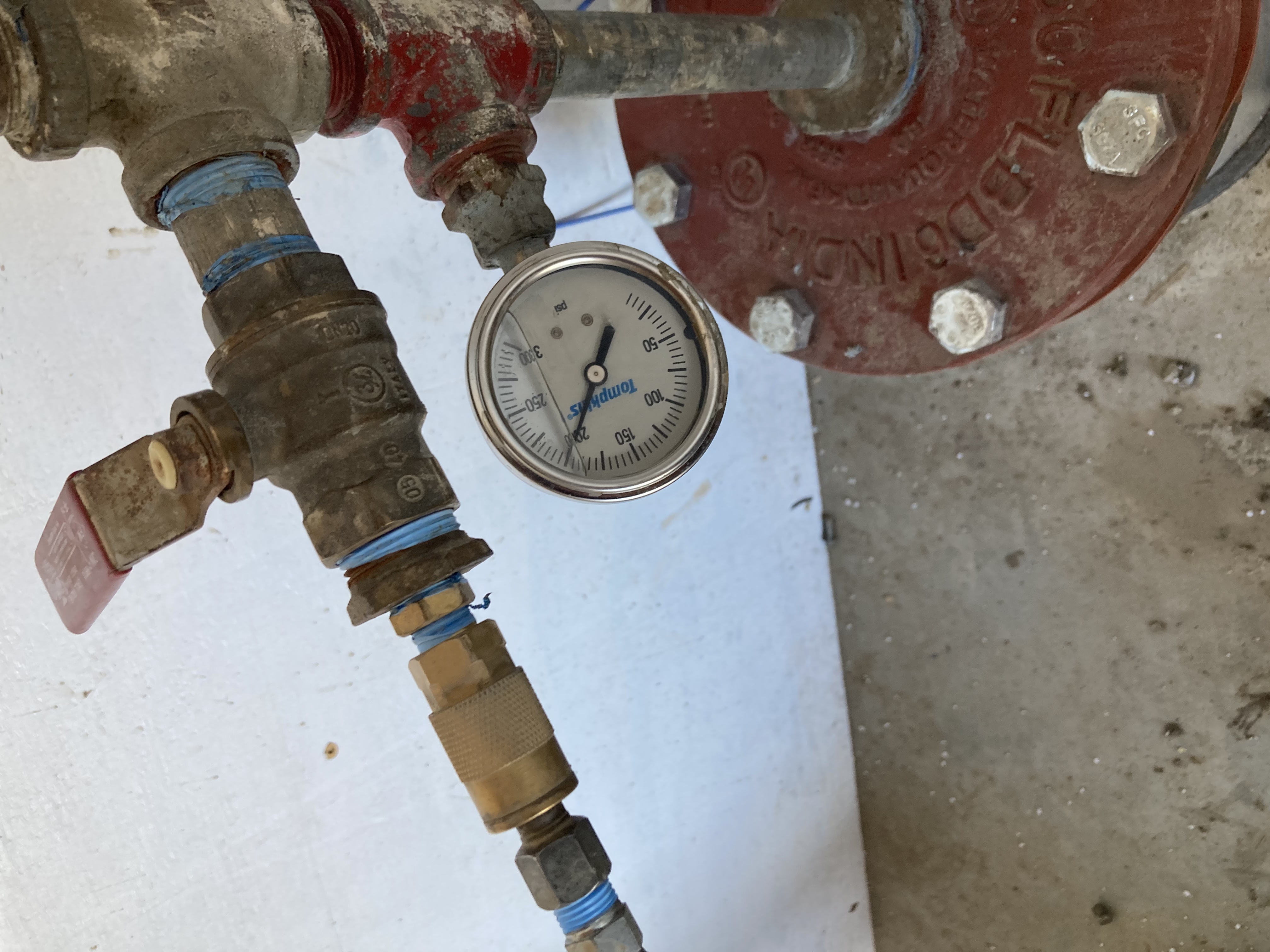

08/22/2022 8-22-22 Hydrostatic test 9am
08/22/2022 49am0
08/22/2022 Letter INSPECTION SUMMARY
08/24/2022 Letter INSPECTION SUMMARY
08/24/2022 Letter INSPECTION SUMMARY
08/26/2022 Letter INSPECTION SUMMARY
08/31/2022 Letter INSPECTION SUMMARY
09/01/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY
09/02/2022 Letter INSPECTION SUMMARY

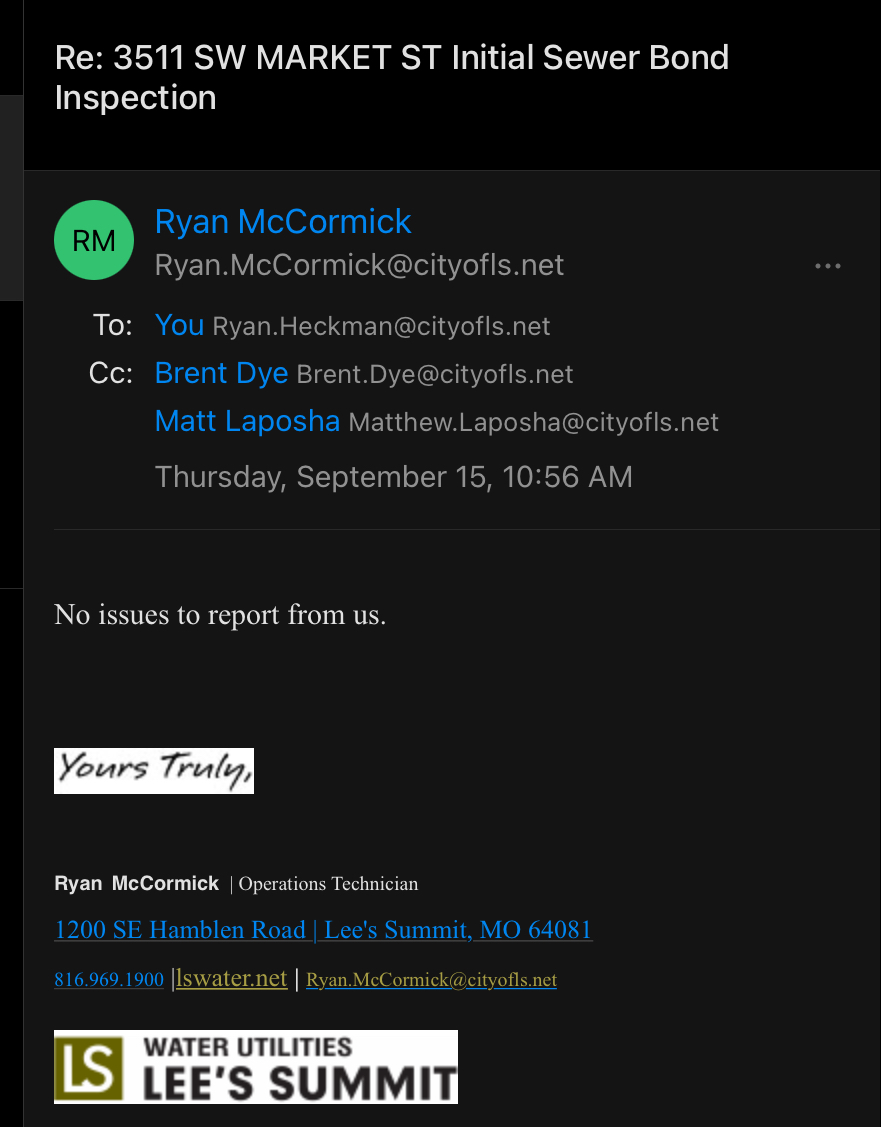

09/02/2022 Water Tie In 9-2-22

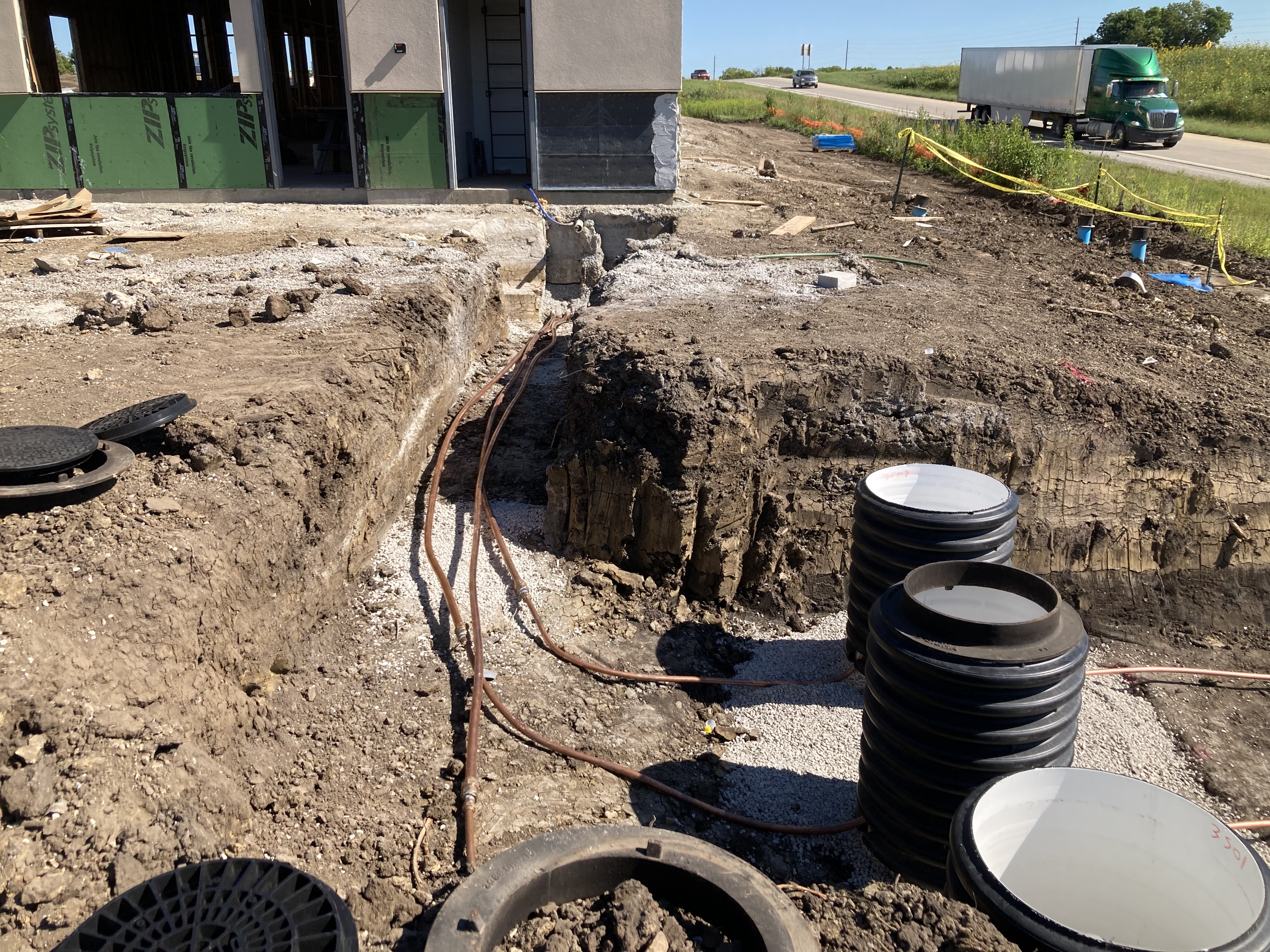

09/02/2022 Water Tie in 9-2-23
09/06/2022 Letter INSPECTION SUMMARY
09/06/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/07/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/12/2022 Letter INSPECTION SUMMARY
09/13/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Passing Camera Test
09/15/2022 Letter INSPECTION SUMMARY
09/15/2022 Letter INSPECTION SUMMARY
09/16/2022 Letter INSPECTION SUMMARY
09/16/2022 Letter INSPECTION SUMMARY
09/20/2022 Letter INSPECTION SUMMARY

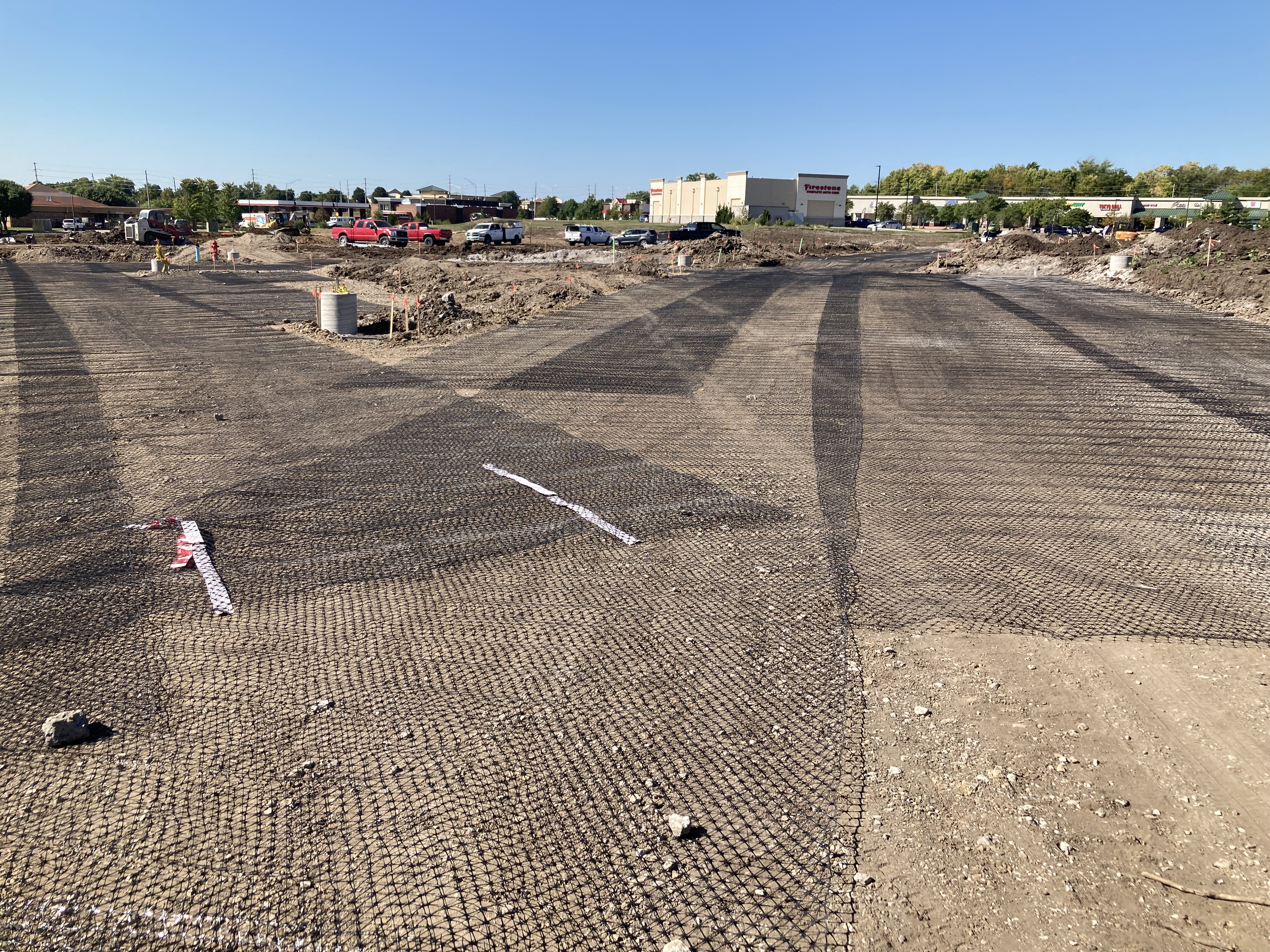

09/20/2022 Geogrid Placement
09/20/2022 Letter INSPECTION SUMMARY
09/21/2022 Letter INSPECTION SUMMARY
09/21/2022 Letter INSPECTION SUMMARY
09/21/2022 Letter INSPECTION SUMMARY

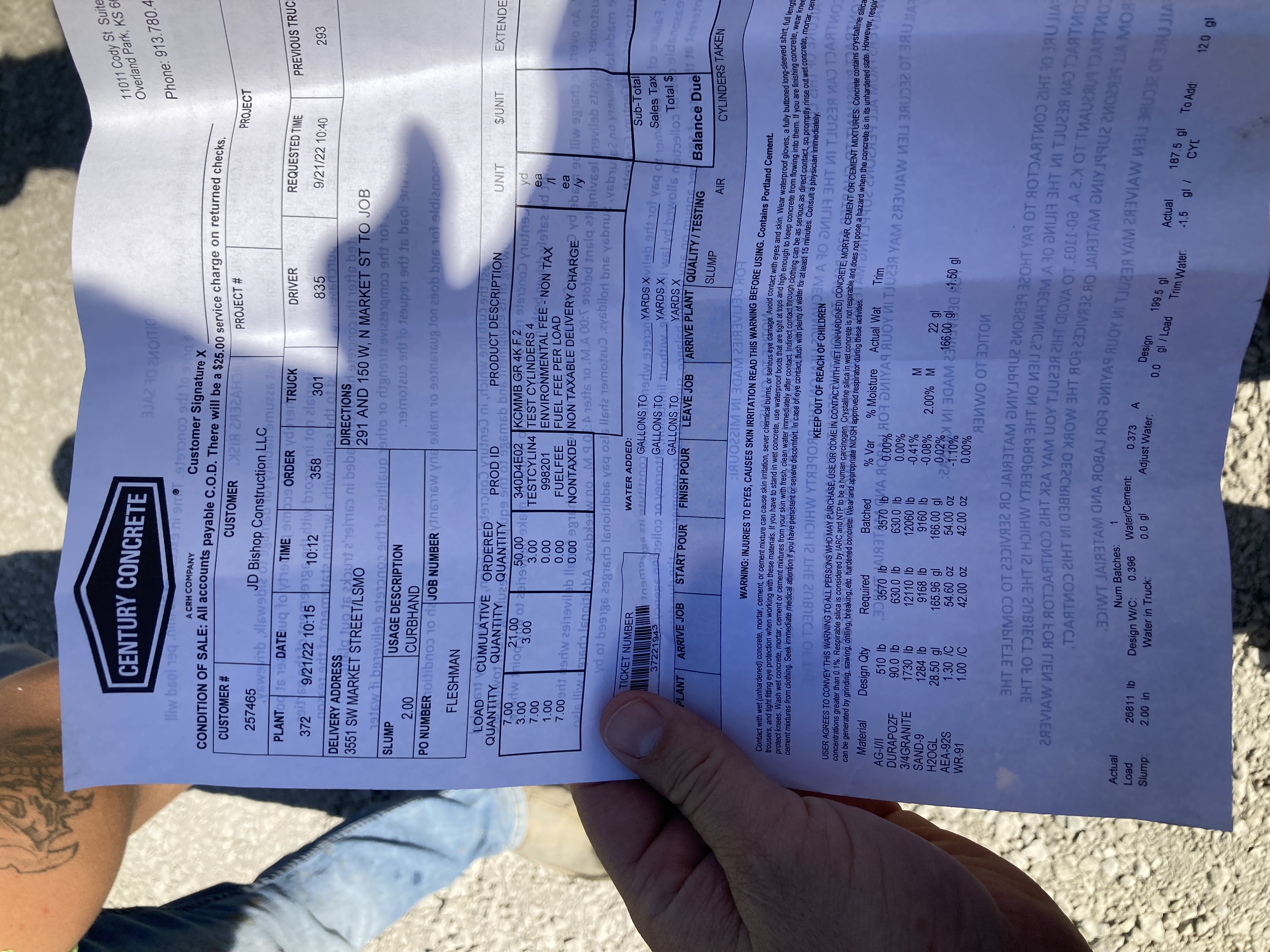

09/22/2022 9-21-22 Concrete Curb Ticket
09/22/2022 Letter INSPECTION SUMMARY
09/23/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/26/2022 Letter INSPECTION SUMMARY
09/27/2022 Letter INSPECTION SUMMARY
09/30/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/03/2022 Letter INSPECTION SUMMARY
10/06/2022 Letter INSPECTION SUMMARY
10/06/2022 Approved Plans approved - 21.188.05 aSheets 220412 rev 3-A1
10/07/2022 Letter INSPECTION SUMMARY
10/10/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/11/2022 Letter INSPECTION SUMMARY
10/13/2022 Letter INSPECTION SUMMARY
10/13/2022 Letter INSPECTION SUMMARY

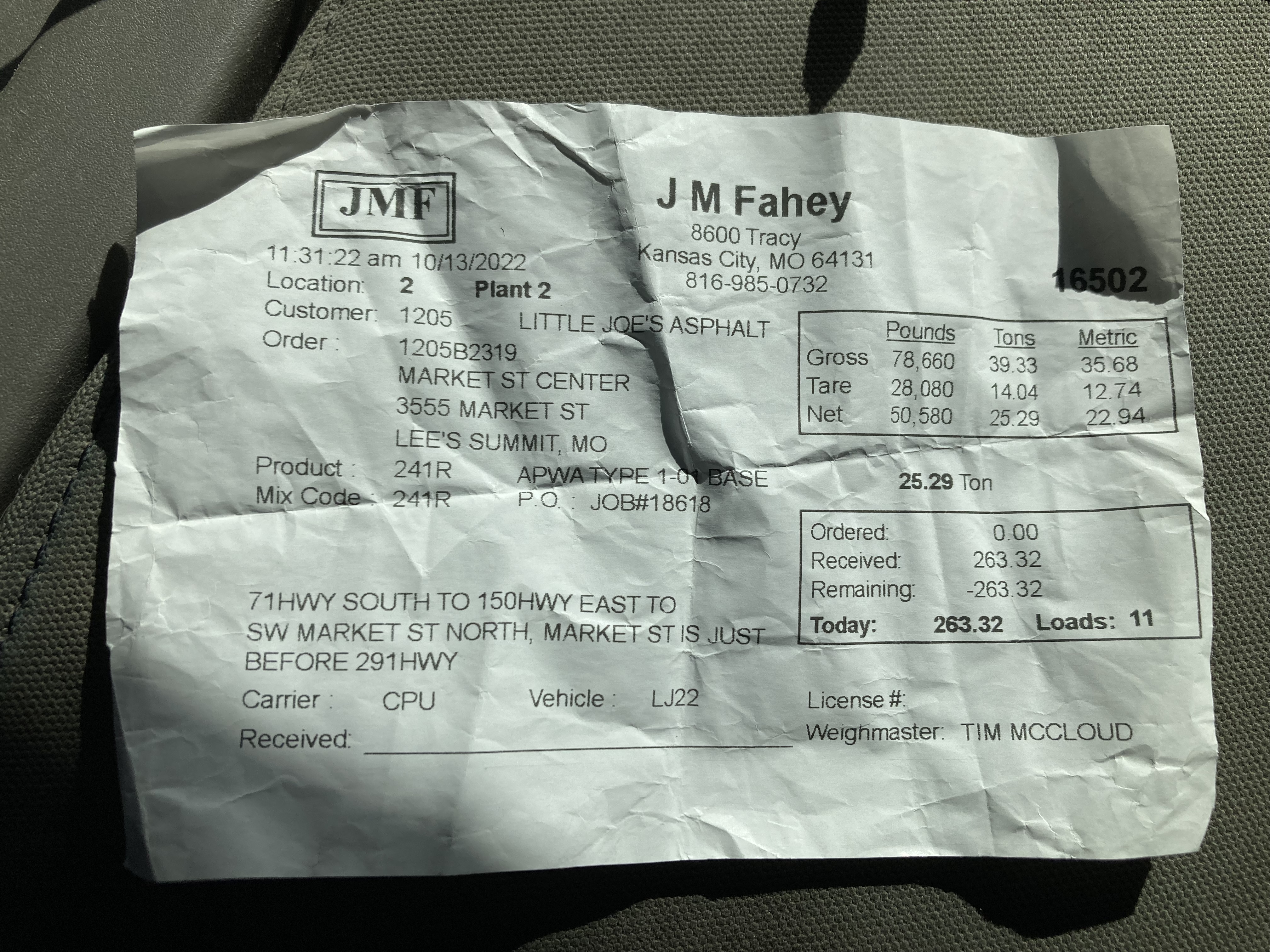

10/13/2022 Asphalt Base Ticket
10/14/2022 Letter INSPECTION SUMMARY
10/17/2022 Letter INSPECTION SUMMARY
10/17/2022 Letter INSPECTION SUMMARY
10/17/2022 Letter INSPECTION SUMMARY
10/18/2022 Letter INSPECTION SUMMARY
10/19/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
10/20/2022 Letter INSPECTION SUMMARY
10/24/2022 Letter INSPECTION SUMMARY
10/24/2022 Letter INSPECTION SUMMARY
10/25/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
10/31/2022 Letter INSPECTION SUMMARY
11/01/2022 Letter INSPECTION SUMMARY
11/04/2022 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/03/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/04/2023 Letter INSPECTION SUMMARY
01/11/2023 2023_01_11 Final Special Inspection Report
01/18/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/17/2023 Letter INSPECTION SUMMARY
02/21/2023 Letter Fire Loss Reduction Form
02/27/2023 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
