Permit Application Status

PRSUBD20191376


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20191376
Public Infrastructure
Final Acceptance
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
STREETS OF WEST PRYOR SANITARY
05/29/2019
06/21/2019
02/29/2024
Locations
Contacts
CITY OF LEES SUMMIT, Address:PO BOX 1600
STREETS OF WEST PRYOR LLC, Address:7200 W 132ND ST STE 150
SCHALLERT JOHN G & GLORIA S, Address:801 NW BLACK TWIG LN
MATTIS GARY&SHIRLEY, Address:803 BLACK TWIG
GIBBS JOSHUA D & KELLSI J, Address:711 NW BLACK TWIG LN
HALL CALEB & JOCELYN A, Address:713 NE BLACK TWIG LN
RAAJA INVESTMENTS LLC, Address:PO BOX 7125
VEGA ERIKA L & MATTHEW J, Address:2106 NW CHIPMAN RD
WEST PRYOR VILLAGE LLC, Address:12701 METCALF AVE STE 100
EMERY SAPP AND SONS INC, Address:2301 I-70 DR NW, Phone:(573) 445-8331
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 05/29/2019 05/29/2019
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 05/29/2019
91100C8-Sanitary Sewer Insp Fees $11,644.89 $11,644.89 Paid 05/29/2019
9110071-Site Grading Fee $469.43 $469.43 Paid 05/29/2019
9110069-After Hours Inspections (Public Works)(Per Hour) $100.00 $100.00 Paid 07/08/2020
9110069-After Hours Inspections (Public Works)(Per Hour) $145.00 $145.00 Paid 07/08/2020
9110069-After Hours Inspections (Public Works)(Per Hour) $245.00 $245.00 Paid 07/08/2020
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

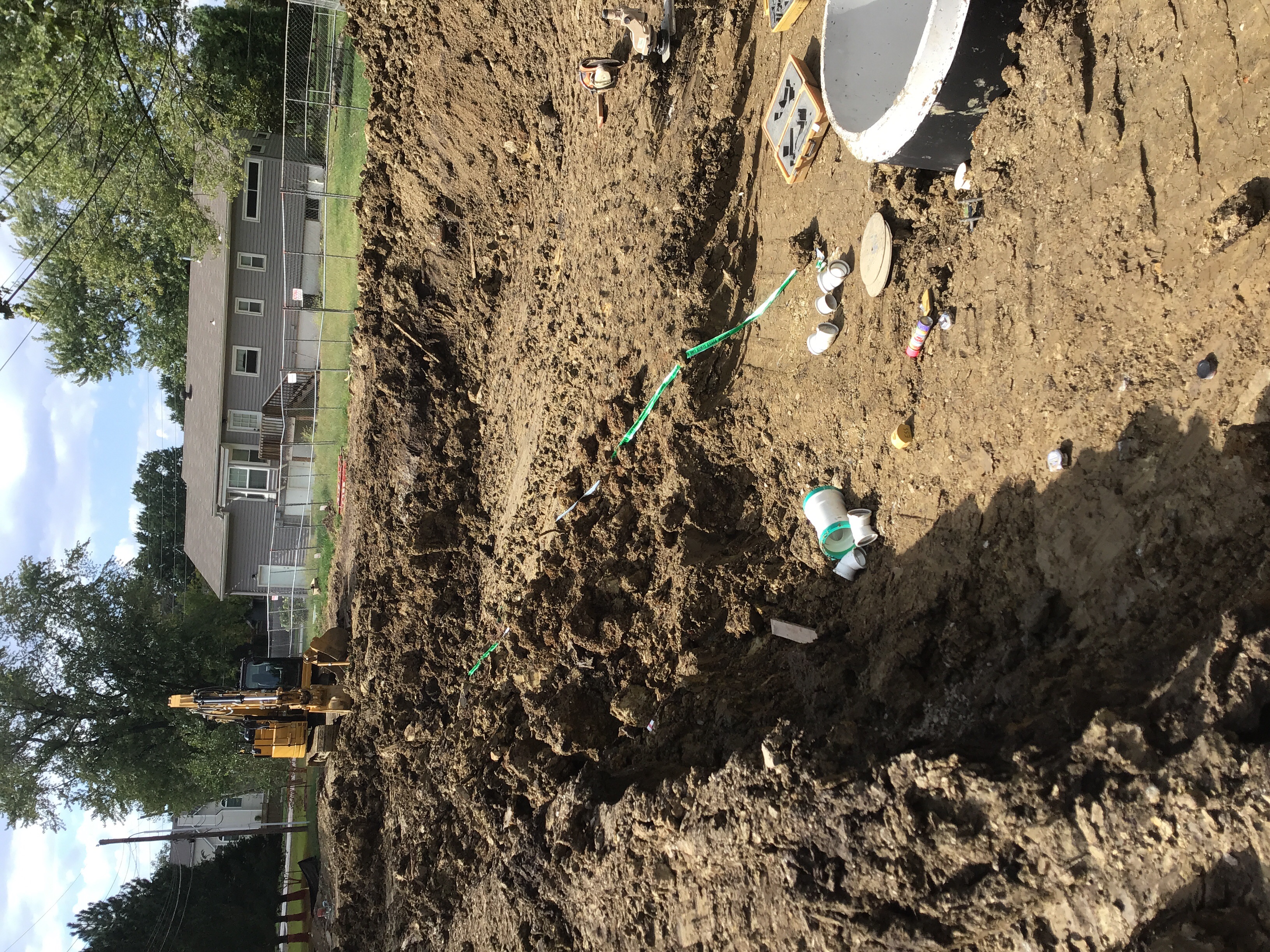

Sanitary Sewer Construction Inspection Partial 6/28/2019 06/28/2019
Misc
Informational
06/28/2019

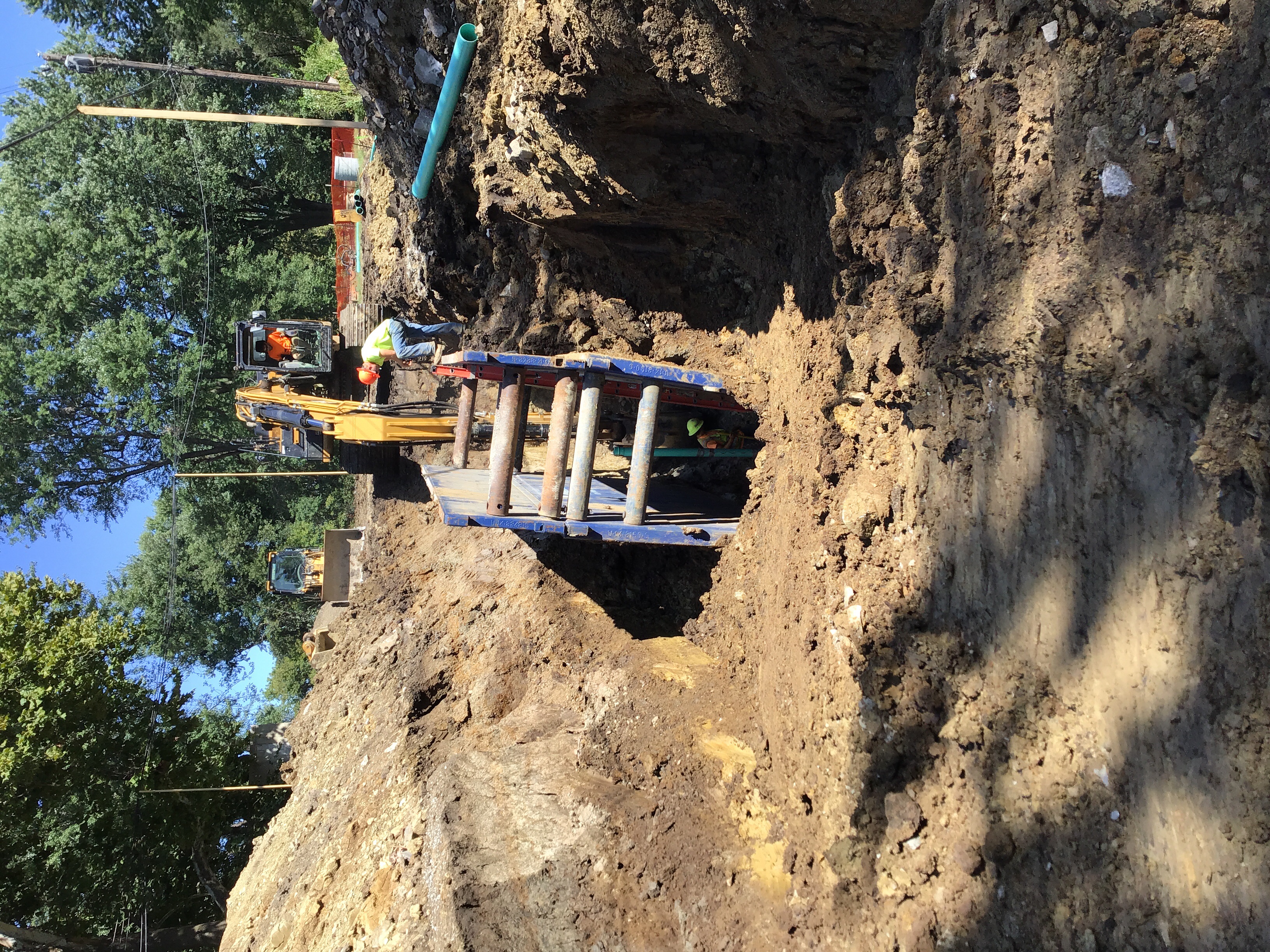

John DiMauro 06/28/2019 2:46 PM The ESS crew starting work on the 8" sanitary sewer main install on Wednesday 6/26/19. The crew set MH A-7 and installed approximately 50'ft of the line towards MH A-8. On Thursday 6/27/19 the crew noticed that the flow line was off and after trouble shooting found that their laser was off. After the crew corrected their laser and removed the installed line they now have approximately 140'ft of the 8" sewer line installed.
Sanitary - Material Verification Passed 7/11/2019 07/11/2019
Misc
Informational
07/11/2019
They are using SDR 26 sanitary pipes. Manholes were made by Barbour Concrete. They have ML-13-NCR steps installed. Manhole lids were manufactured by EJ. They are model 1502.
Sanitary Sewer - Invert Partial 7/11/2019 07/11/2019
Misc
Informational
07/11/2019
Rudy’s crew from ESS poured inverts for MH 8 and MH 9. RP 7-11-19
Sanitary Sewer Construction Inspection Partial 7/1/2019 07/13/2019
Misc
Informational
07/13/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Sanitary Sewer Construction Inspection Partial 7/15/2019 07/15/2019
Misc
Informational
07/13/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
07/15/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Sanitary Sewer Construction Inspection Partial 7/16/2019 07/17/2019
Misc
Informational
07/15/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
07/15/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
07/17/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Sanitary Sewer Construction Inspection Partial 7/18/2019 07/18/2019
Misc
Informational
07/17/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
07/17/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
07/17/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
07/18/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Sanitary Sewer Construction Inspection Partial 7/19/2019 07/29/2019
Misc
Informational
07/18/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
07/18/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
07/18/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
07/18/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
07/29/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Sanitary Sewer Construction Inspection Partial 7/31/2019 08/01/2019
Misc
Informational
07/29/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
07/29/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
07/29/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
07/29/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
07/29/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/01/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Water Line - Construction Inspection Partial 7/23/2019 08/01/2019
Misc
Informational
08/01/2019
Rudy’s crew replaced Robert’s crew and is repairing the water line. They addd a 22 degree wye in the line to assist in the bend. They laid 250 feet of 12 inch water line. RP 7-31-19
Water - Material Verification Passed 7/24/2019 08/02/2019
Misc
Informational
08/02/2019

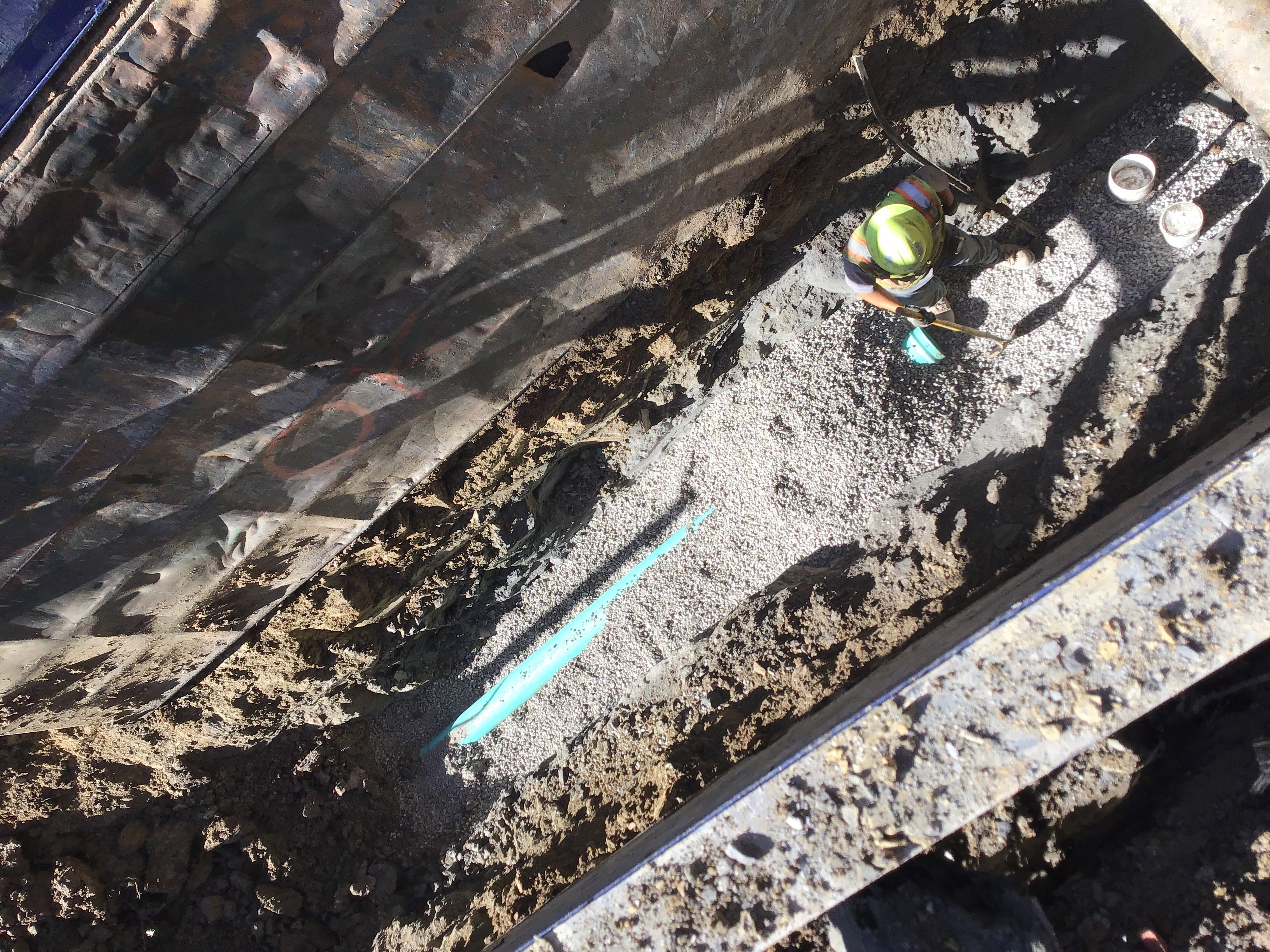

C 900 water pipe manufactured by North American Pipe Company in 6, 8, and 12 inch sizes. 8 and 12 inch C 153 MJB’s in 11 1/4, 22 1/2, 45 and 90 degrees. 12 x 12 x 12, 12 x 12 x 8, and 12 x 12 x 6, 8 x 8x 6 inch C 153 MJT’s. 12 x 8 and 12 x 6 inch C 153 MJR’s. 8 x 6 inch C 153 MJR’s. 12 inch C 153 MJSL’s. 8 inch C 153 MJP. 6 inch gate vale and 12 inch butterfly valves.
Water Line - Construction Inspection Partial 8/1/2019 08/05/2019
Misc
Informational
08/01/2019
Rudy’s crew replaced Robert’s crew and is repairing the water line. They addd a 22 degree wye in the line to assist in the bend. They laid 250 feet of 12 inch water line. RP 7-31-19
Misc
Informational
08/05/2019
Rudy’s crew tied in to line A water line to existing water main at the corner of Lowenstein and Pryor. They also set fire hydrant 021-082. RP 8-02-19
Sanitary Sewer Construction Inspection Partial 8/2/2019 08/05/2019
Misc
Informational
08/01/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/01/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/01/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/01/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/01/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/01/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/05/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Sanitary Sewer Construction Inspection Partial 8/5/2019 08/05/2019
Misc
Informational
08/05/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/05/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/05/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/05/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/05/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/05/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/05/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/05/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Sanitary Sewer Construction Inspection Partial 8/6/2019 08/06/2019
Misc
Informational
08/05/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/05/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/05/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/05/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/05/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/05/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/05/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/05/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/06/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Sanitary Sewer Construction Inspection Partial 8/7/2019 08/13/2019
Misc
Informational
08/06/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/06/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/06/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/06/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/06/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/06/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/06/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/06/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/06/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/13/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Sanitary Sewer Construction Inspection Partial 8/15/2019 08/15/2019
Misc
Informational
08/13/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/13/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/13/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/13/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/13/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/13/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/13/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/13/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/13/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/13/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
08/15/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Sanitary Sewer Construction Inspection Partial 8/16/2019 08/16/2019
Misc
Informational
08/15/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/15/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/15/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/15/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/15/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/15/2019

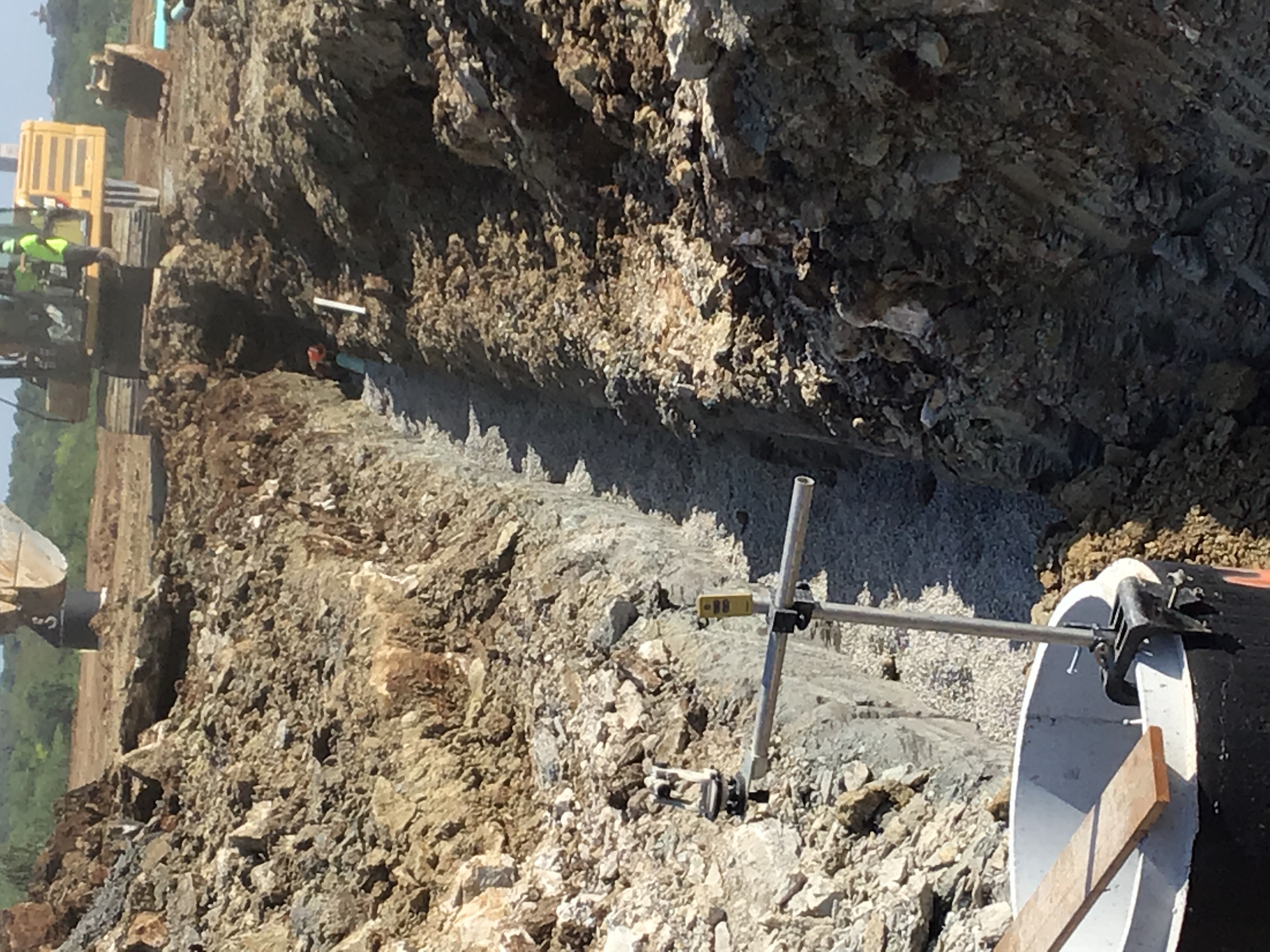

Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/15/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/15/2019

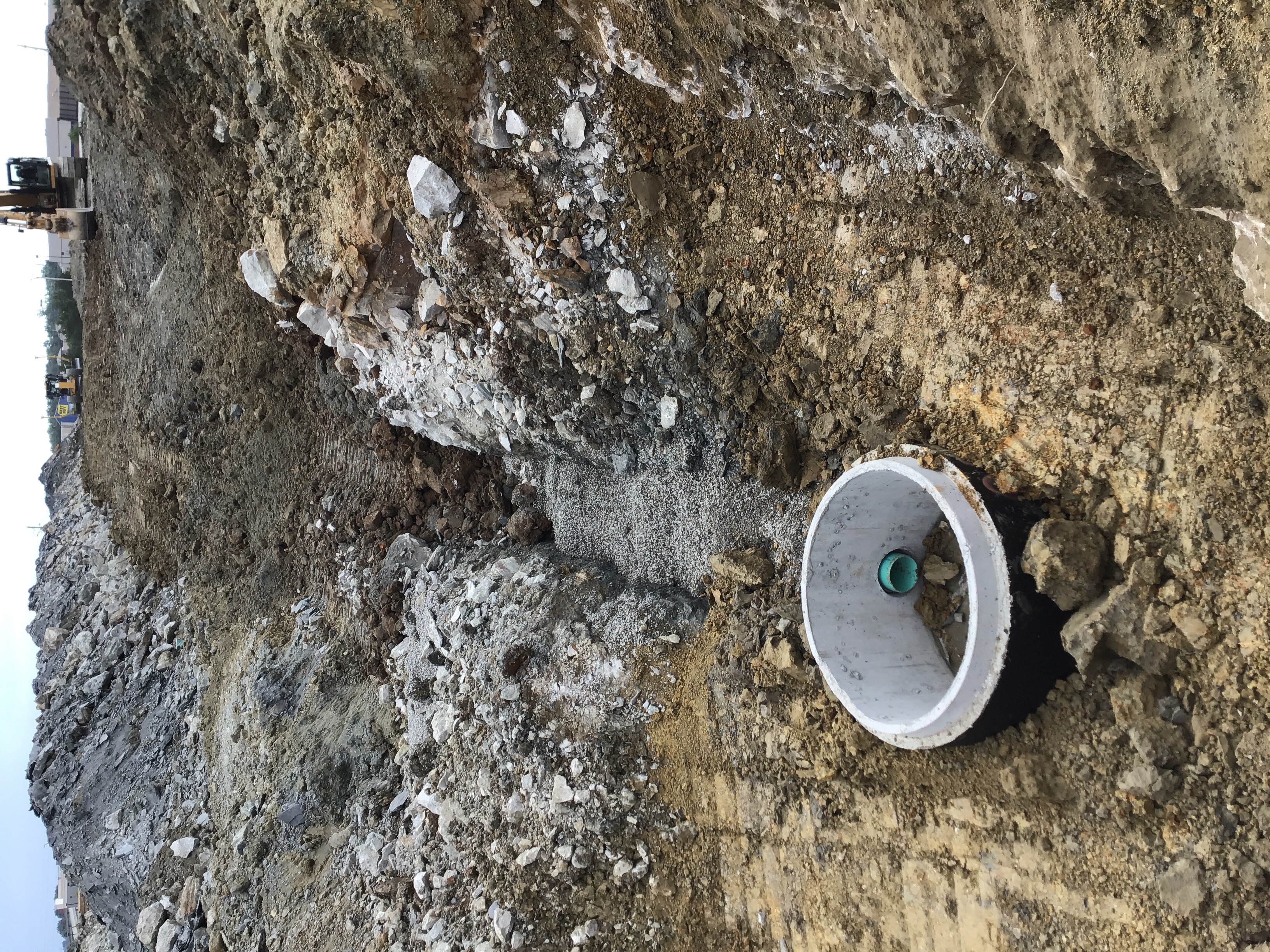

Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/15/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/15/2019

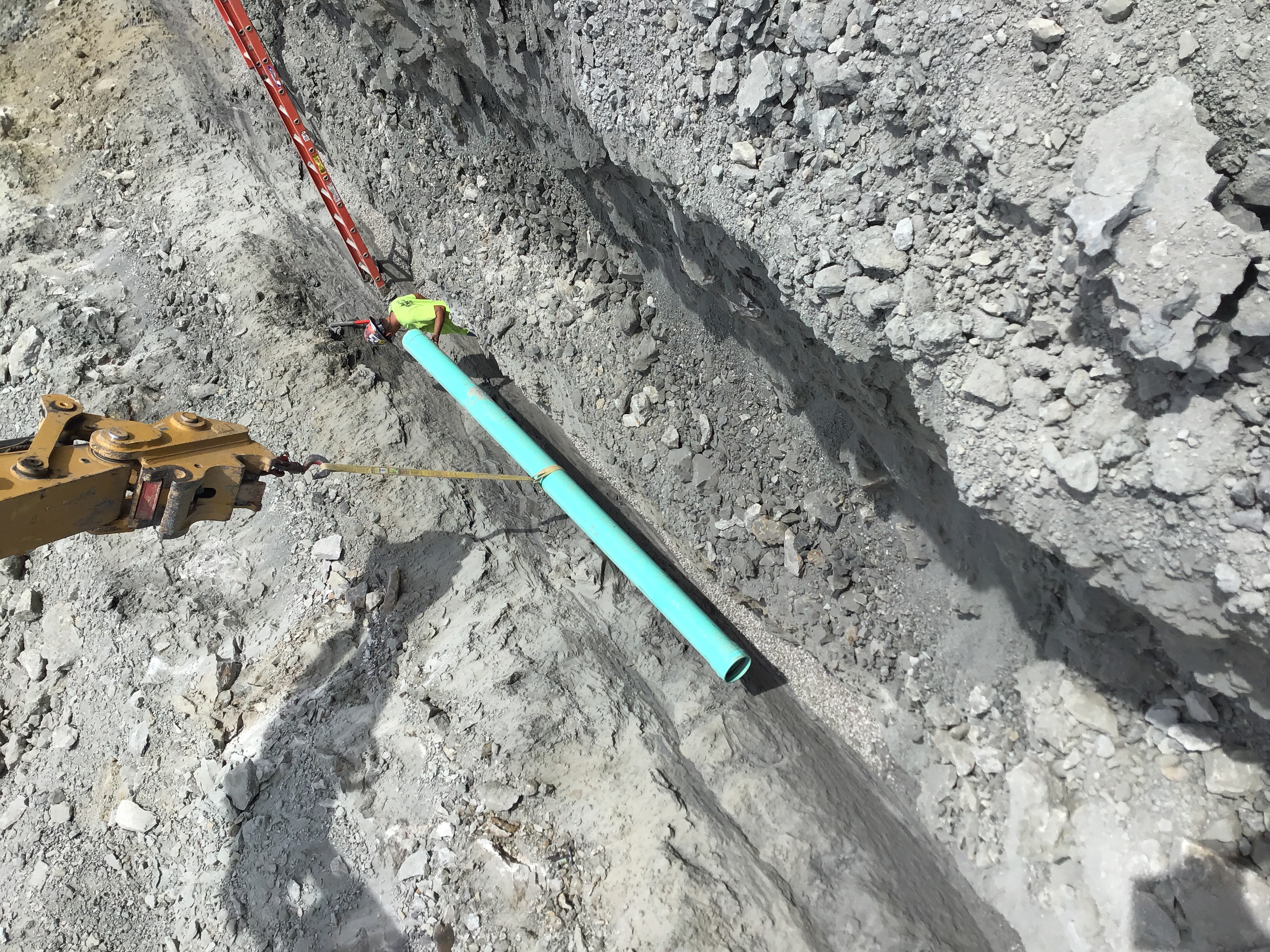

8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
08/15/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
08/16/2019
8-16-19 They have placed 56 feet of sanitary line today.

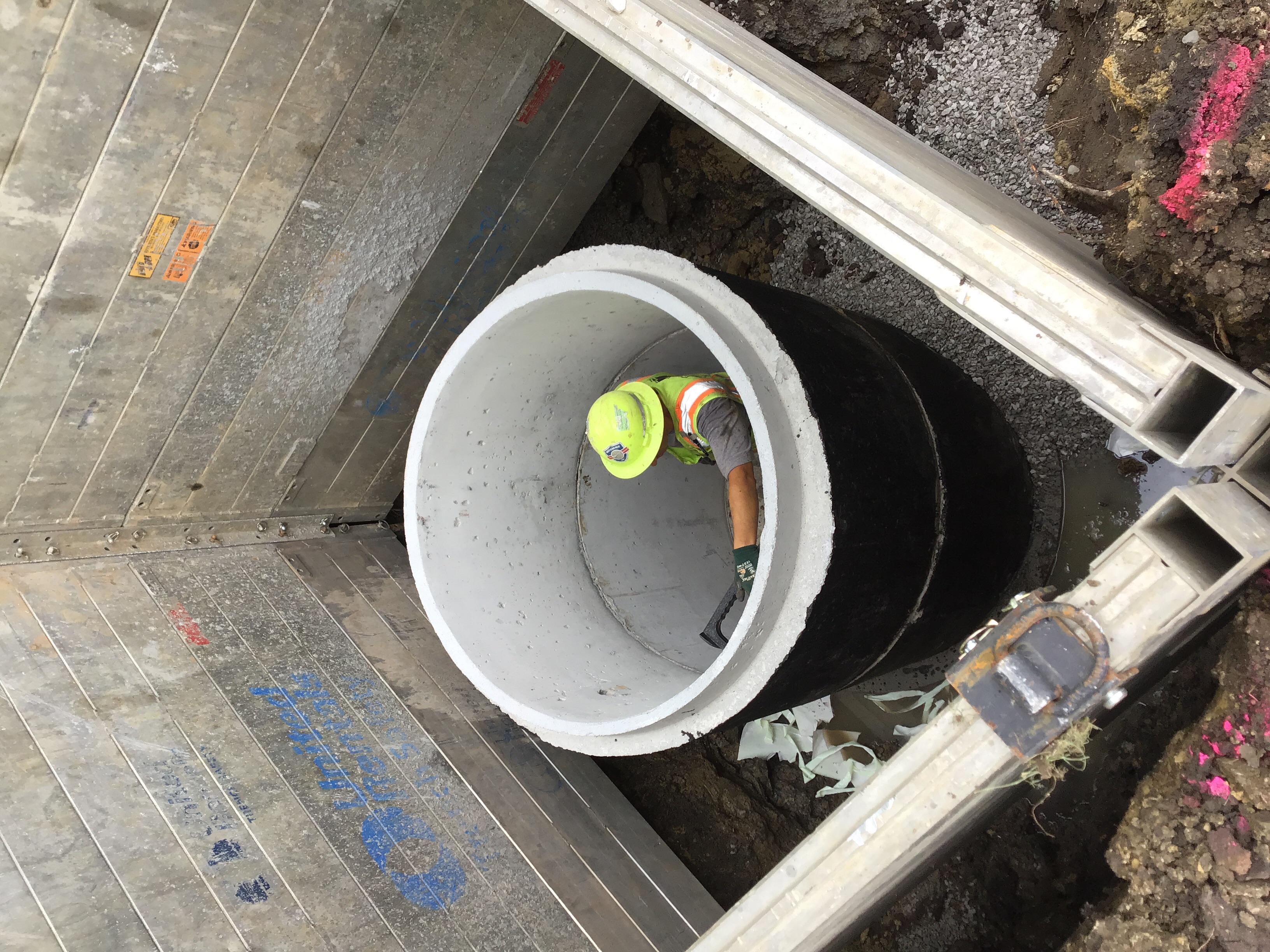

Sanitary Sewer Construction Inspection Partial 8/19/2019 08/20/2019
Misc
Informational
08/16/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/16/2019

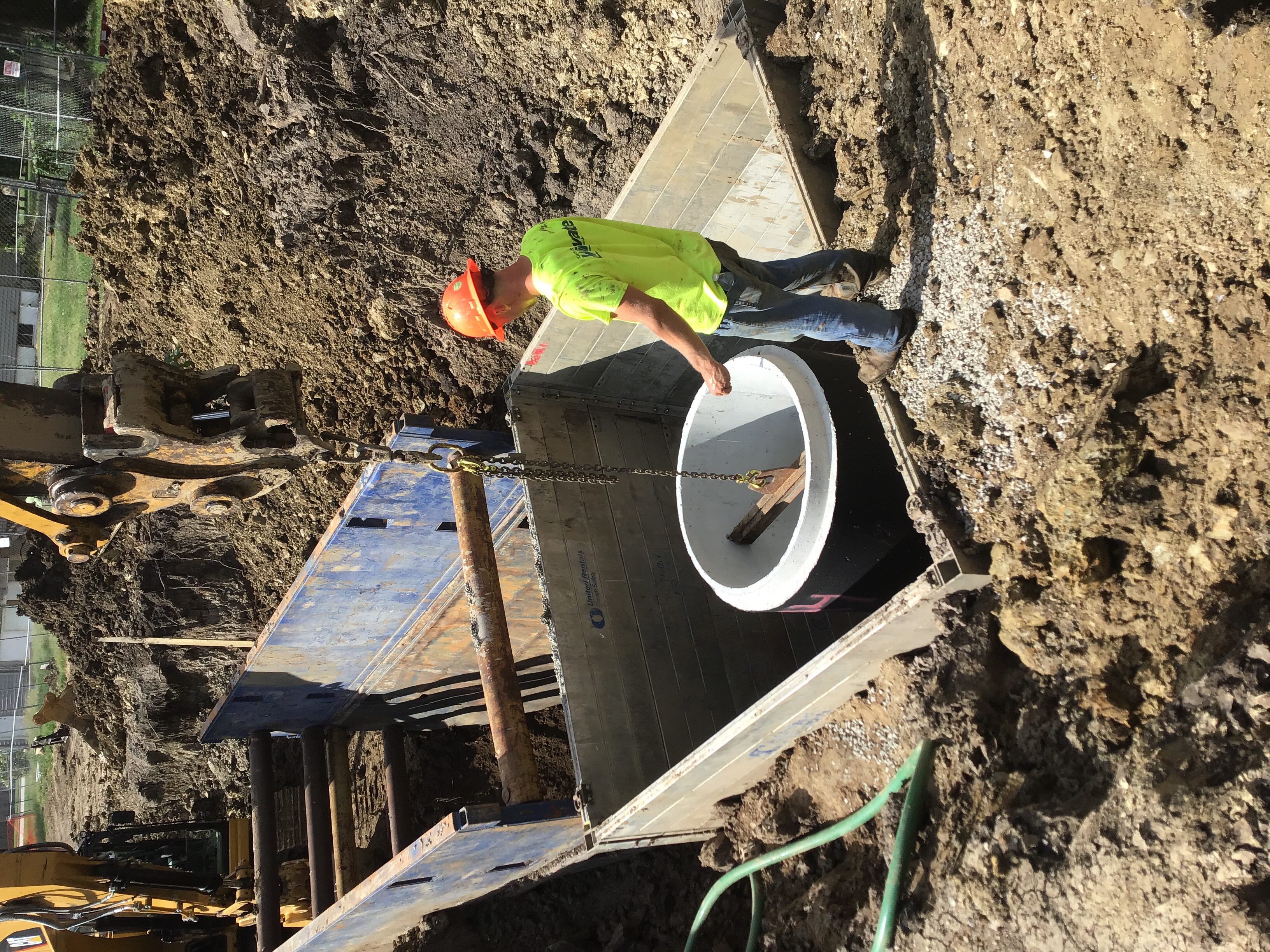

8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/16/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/16/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/16/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/16/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/16/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/16/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/16/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/16/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
08/16/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
08/16/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
08/19/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Sanitary Sewer Construction Inspection Partial 8/20/2019 08/21/2019
Misc
Informational
08/20/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/20/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/20/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/20/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/20/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/20/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/20/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/20/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/20/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/20/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
08/20/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
08/20/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
08/20/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
08/20/2019

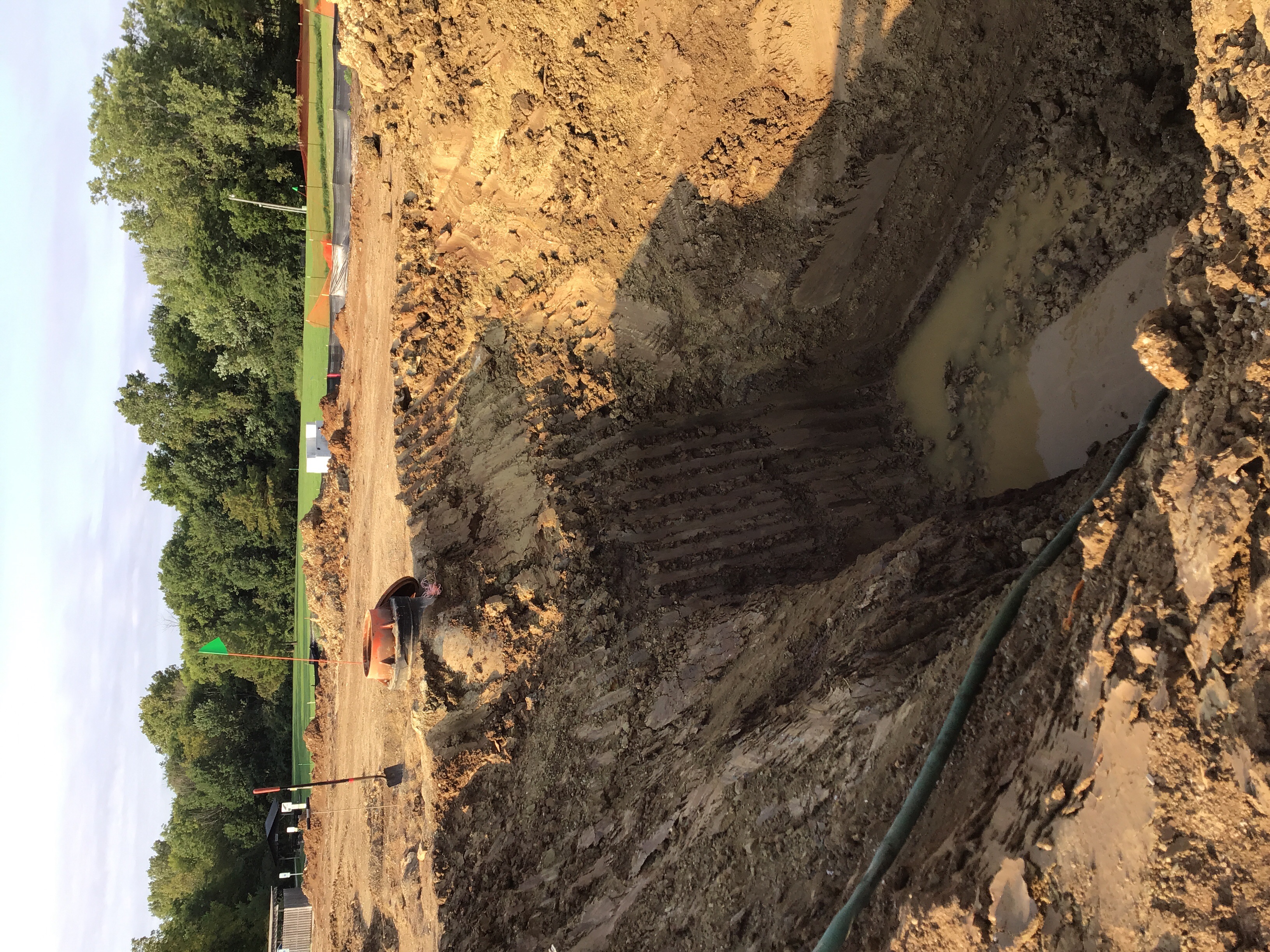

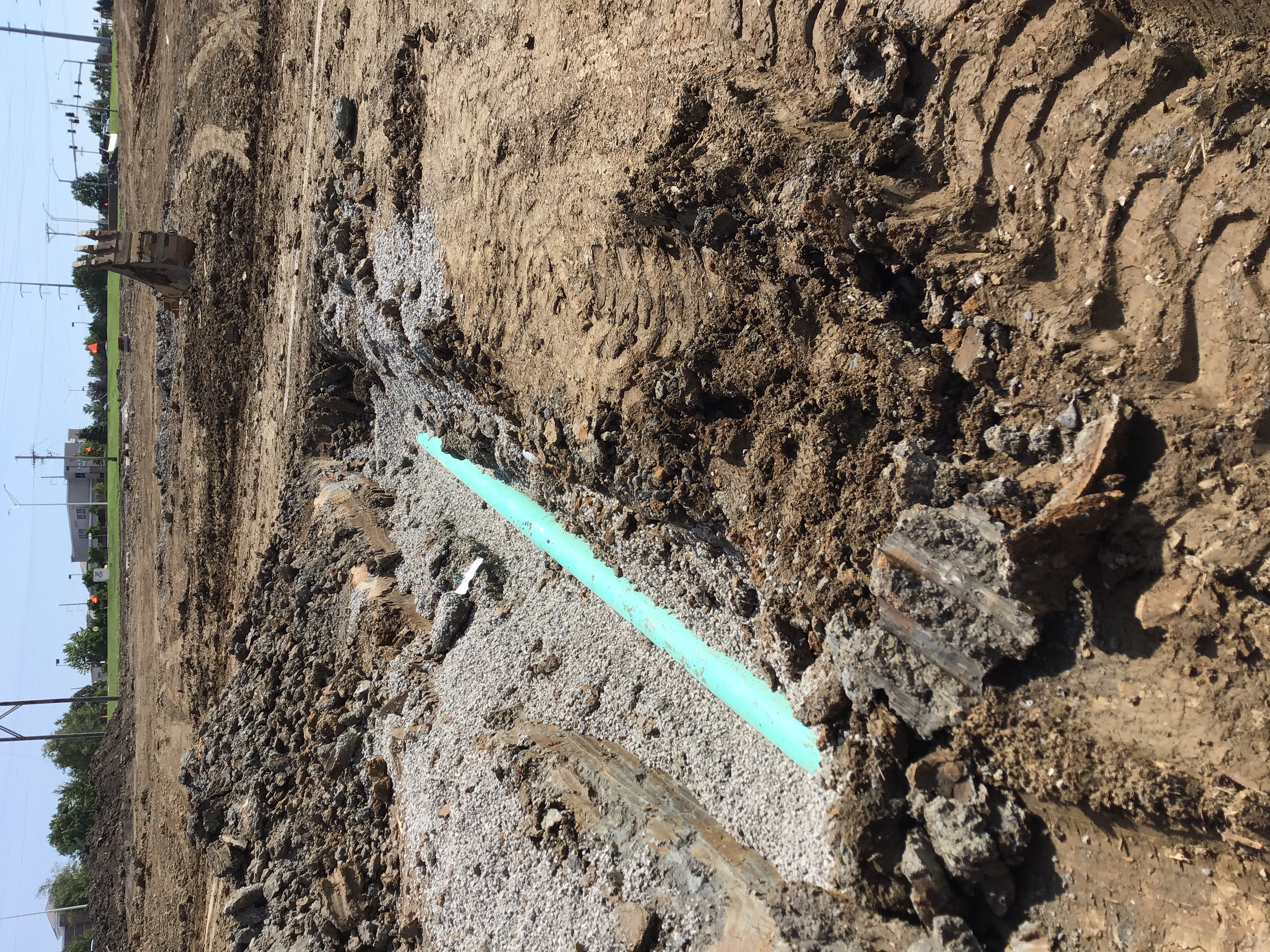

8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
08/21/2019

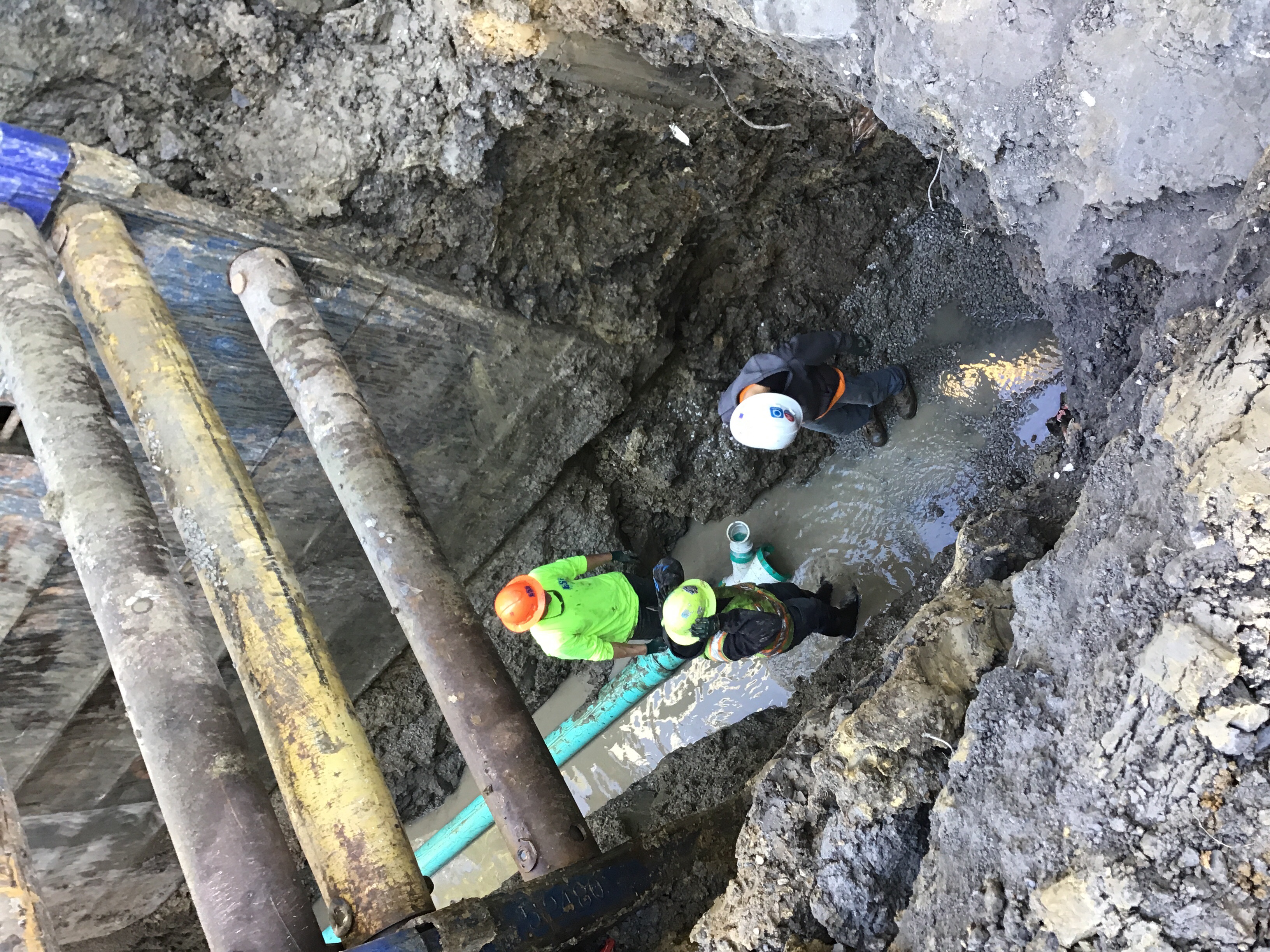

9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Sanitary Sewer - Air Test Partial 9/3/2019 09/03/2019
Misc
Informational
09/03/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Sanitary Sewer - Mandrel Failed 9/3/2019 09/03/2019
Misc
Corrective Action Required
09/03/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19

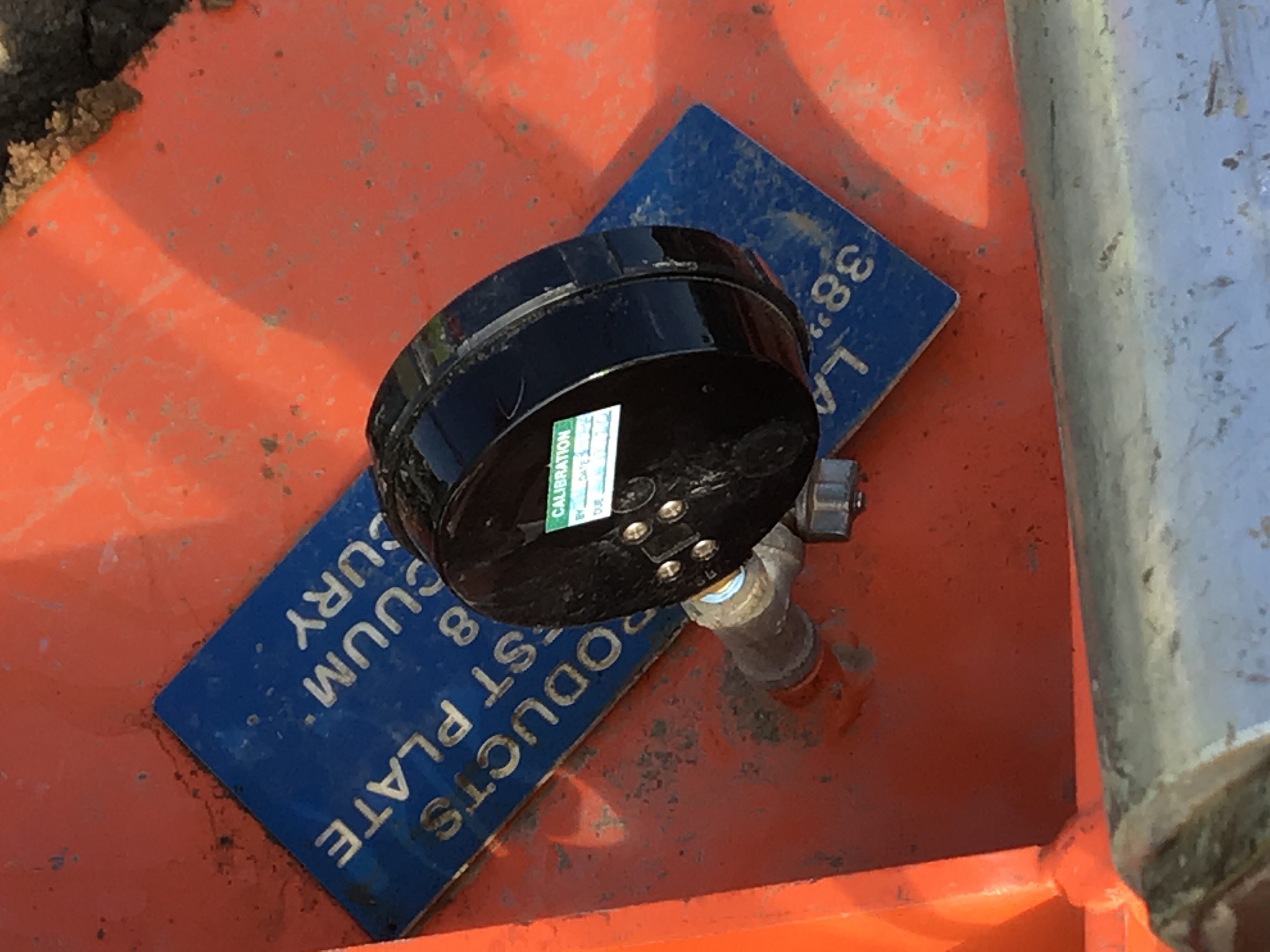

Sanitary Sewer - Vacuum Partial 9/3/2019 09/03/2019
Misc
Informational
09/03/2019

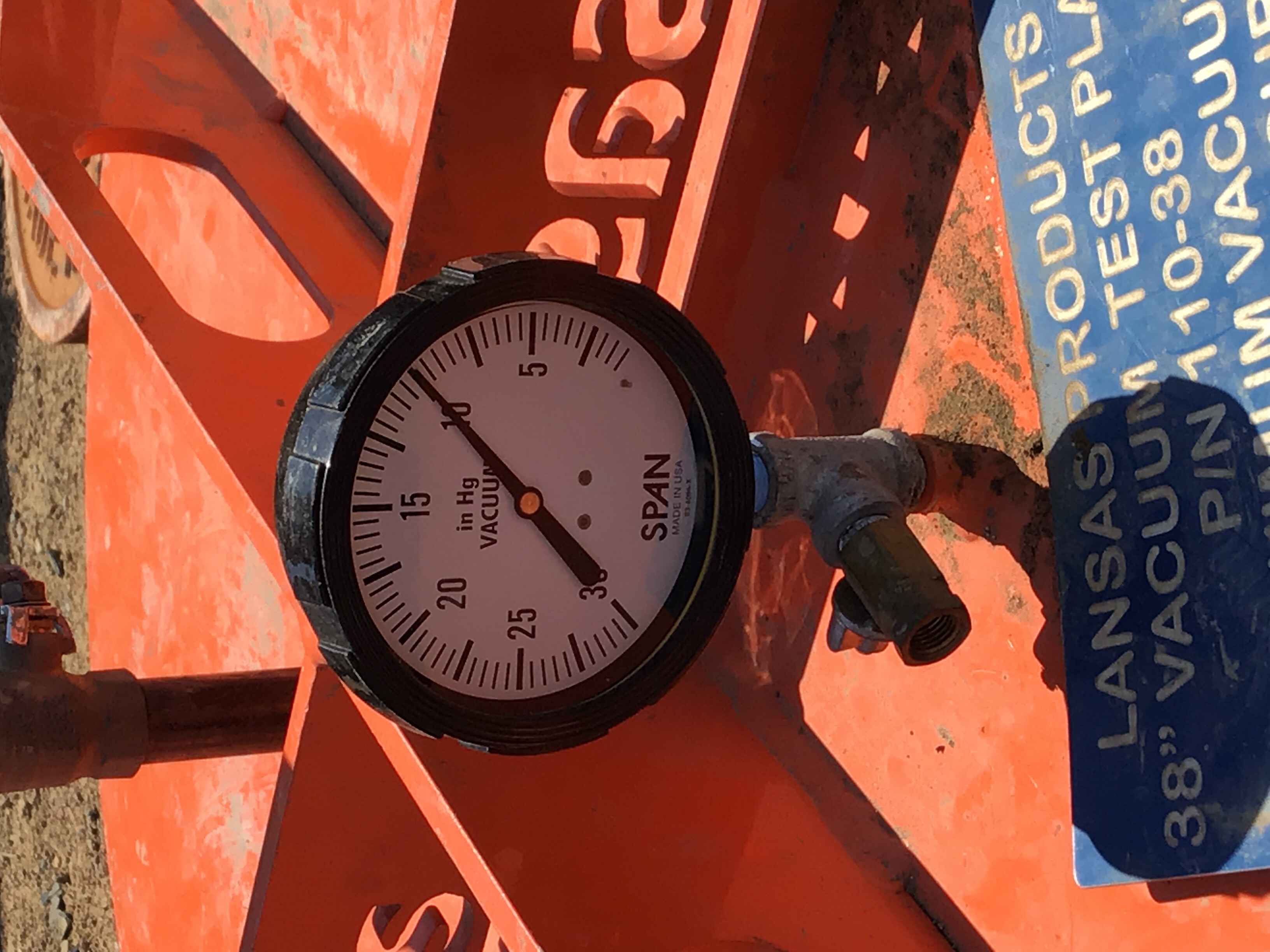

Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Sanitary Sewer - Air Test Partial 9/4/2019 09/04/2019
Misc
Informational
09/03/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Sanitary Sewer Construction Inspection Partial 9/4/2019 09/04/2019
Misc
Informational
08/21/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
08/21/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
08/21/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
08/21/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
08/21/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
08/21/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
08/21/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
08/21/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
08/21/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
08/21/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
08/21/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
08/21/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
08/21/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
08/21/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
08/21/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/04/2019

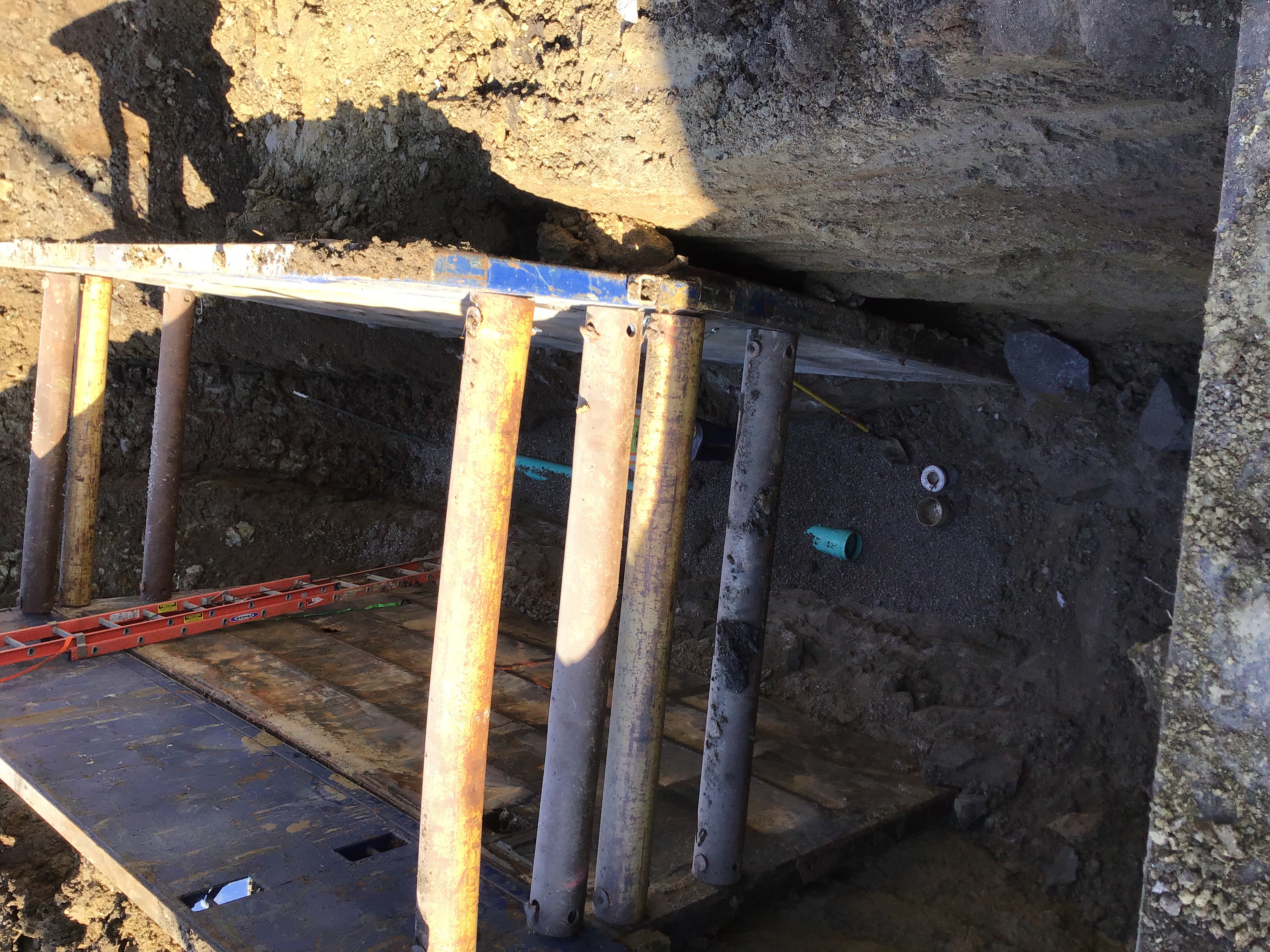

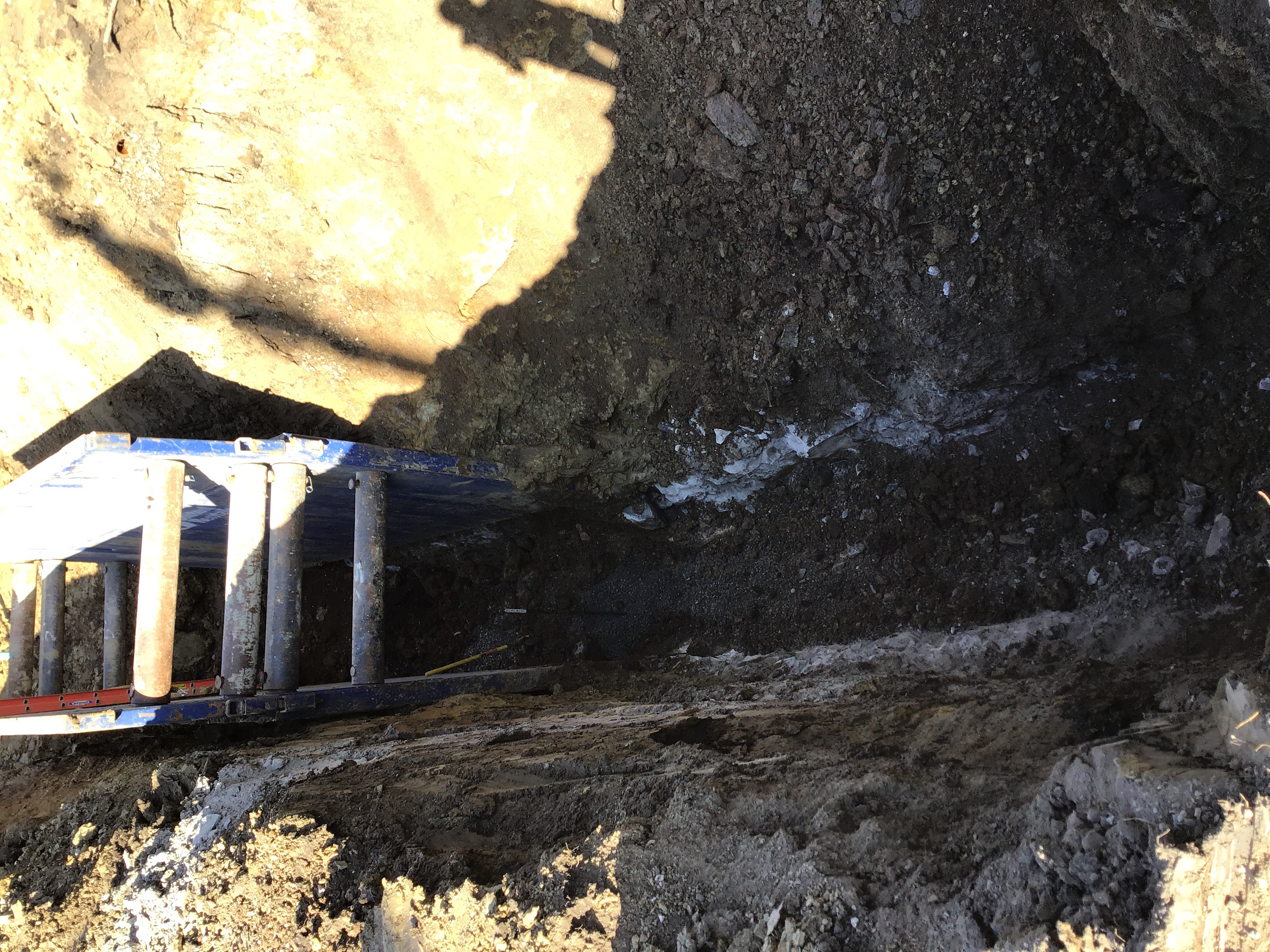

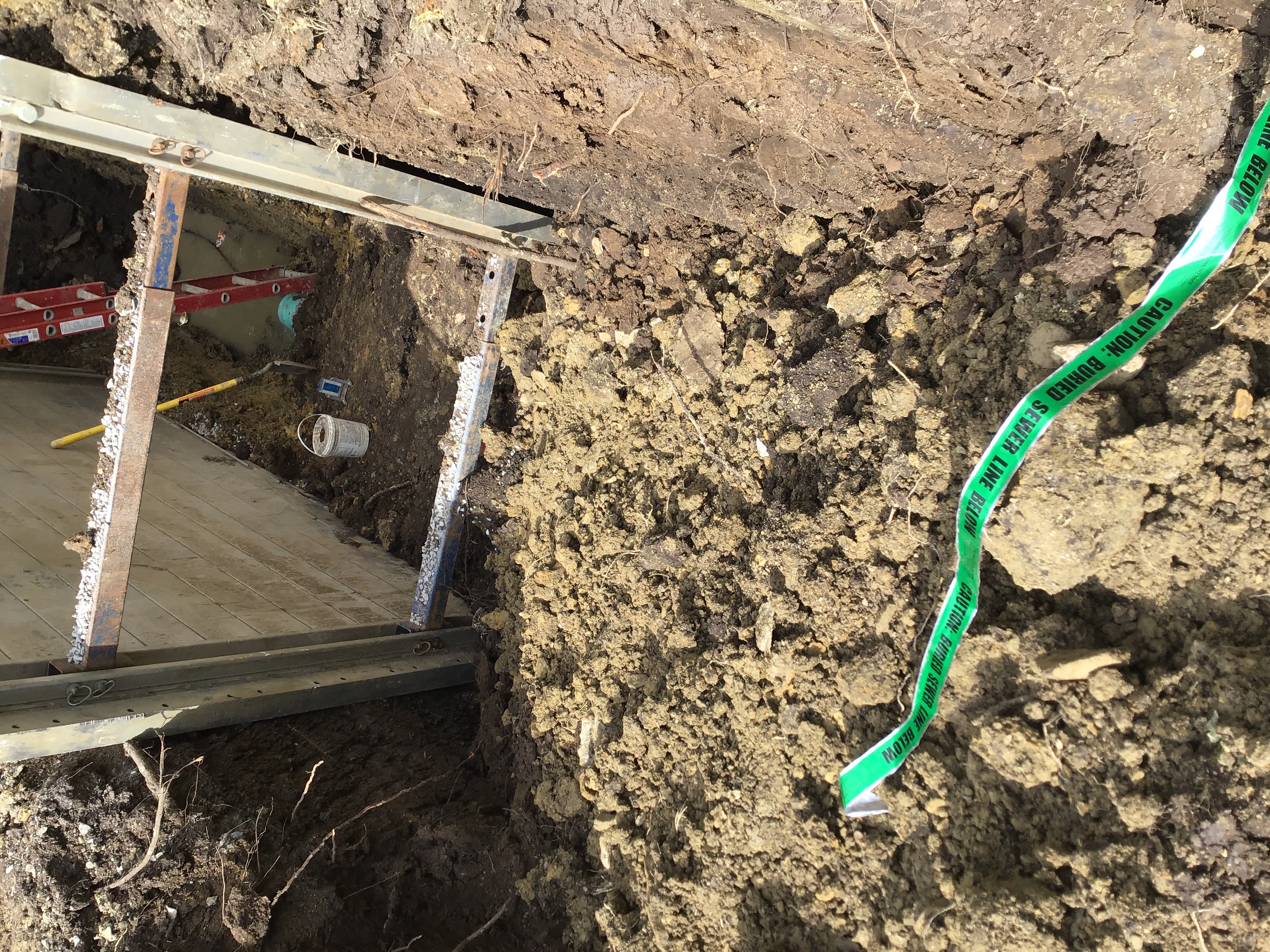

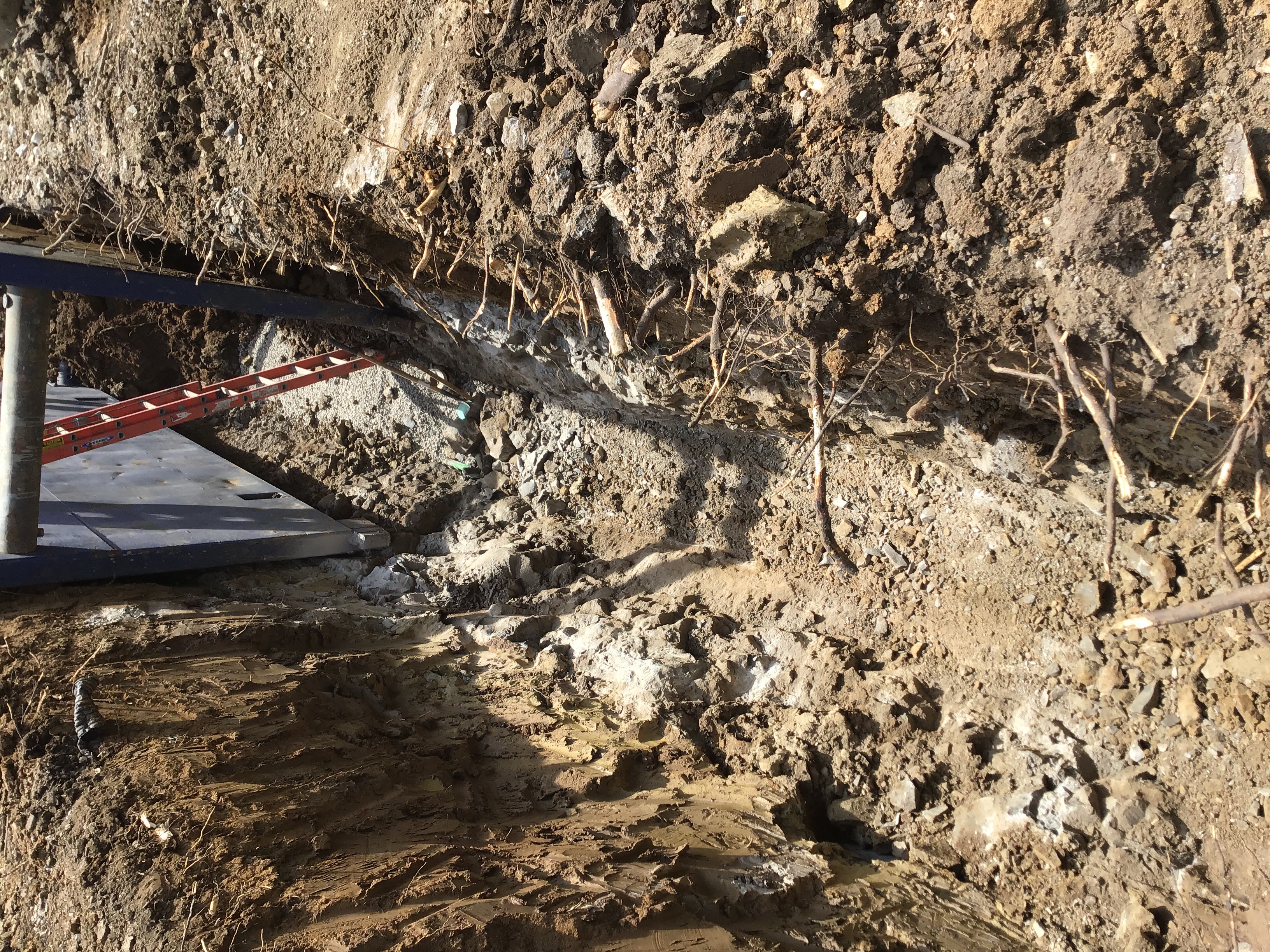

9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019

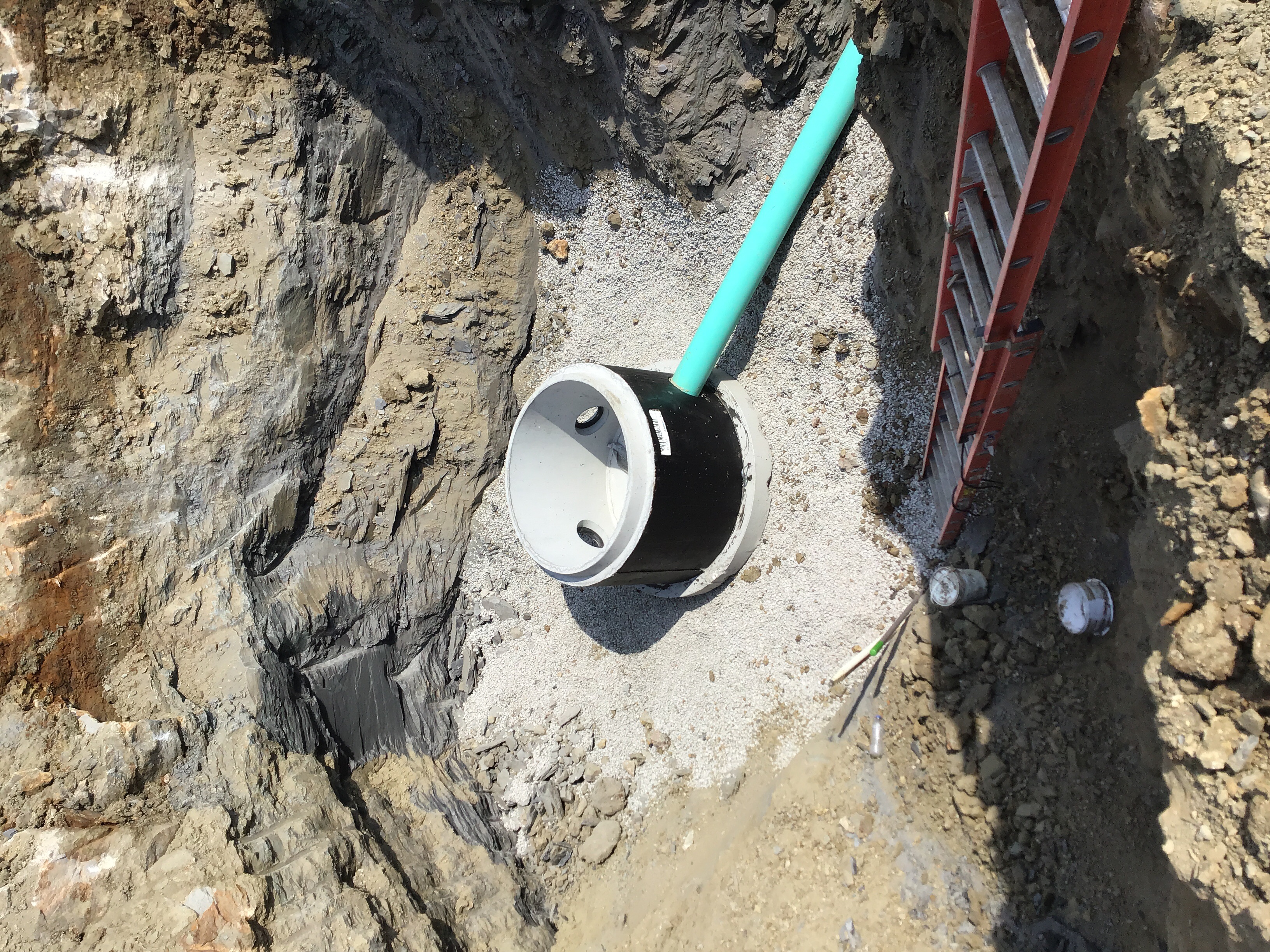

9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Sanitary Sewer - Vacuum Partial 9/4/2019 09/04/2019
Misc
Informational
09/03/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Sanitary Sewer - Mandrel Partial 9/4/2019 09/04/2019
Misc
Corrective Action Required
09/03/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Sanitary Sewer Construction Inspection Partial 9/7/2019 09/07/2019
Misc
Informational
09/04/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/04/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/04/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/04/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/04/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/04/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/04/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/04/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/04/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/04/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/04/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/04/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/04/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/04/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/04/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/07/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Sanitary Sewer - Air Test Partial 9/9/2019 09/09/2019
Misc
Informational
09/04/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
09/09/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Sanitary Sewer - Vacuum Partial 9/9/2019 09/09/2019
Misc
Informational
09/04/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
09/09/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
09/09/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Sanitary Sewer - Mandrel Partial 9/9/2019 09/09/2019
Misc
Corrective Action Required
09/04/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
09/04/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
09/09/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Sanitary Sewer Construction Inspection Partial 9/9/2019 09/09/2019
Misc
Informational
09/07/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/07/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/07/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/07/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/07/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/07/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/07/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/07/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/07/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/07/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/07/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/07/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/07/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/07/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/07/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/07/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/09/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Sanitary Sewer Construction Inspection Partial 9/10/2019 09/10/2019
Misc
Informational
09/09/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/09/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/09/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/09/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/09/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/09/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/09/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/09/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/09/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/09/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/09/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/09/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/09/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/09/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/09/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/09/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/09/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/10/2019
9-10-19 10:58am They are still busting rock at Chipman.
Sanitary Sewer Construction Inspection Partial 9/11/2019 09/11/2019
Misc
Informational
09/10/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/10/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/10/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/10/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/10/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/10/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/10/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/10/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/10/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/10/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/10/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/10/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/10/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/10/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/10/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/10/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/10/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/10/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/10/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/10/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/10/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/10/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/10/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/10/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/10/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/10/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/11/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Sanitary Sewer Construction Inspection Partial 9/12/2019 09/12/2019
Misc
Informational
09/11/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/11/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/11/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/11/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/11/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/11/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/11/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/11/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/11/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/11/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/11/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/11/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/11/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/11/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/11/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/11/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/11/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/11/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/11/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/11/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/11/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/11/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/11/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/11/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/11/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/11/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/11/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/12/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Sanitary Sewer Construction Inspection Partial 9/13/2019 09/13/2019
Misc
Informational
09/12/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/12/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/12/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/12/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/12/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/12/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/12/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/12/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/12/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/12/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/12/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/12/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/12/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/12/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/12/2019

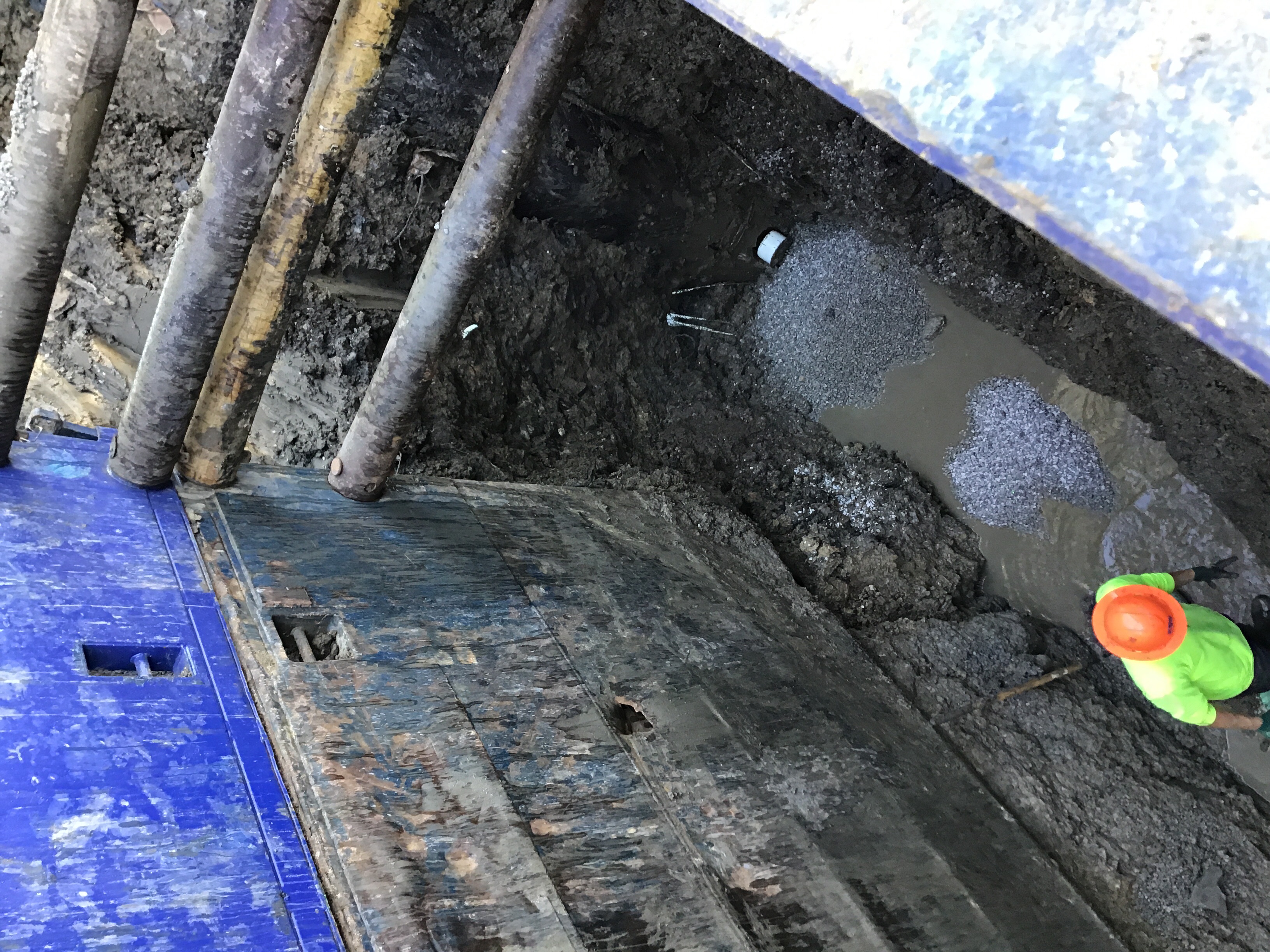

9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/12/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/12/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/12/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/12/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/12/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/12/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/12/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/12/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/12/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/12/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/12/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/12/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/12/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/13/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Sanitary Sewer Construction Inspection Partial 9/14/2019 09/14/2019
Misc
Informational
09/13/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/13/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/13/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/13/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/13/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/13/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/13/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/13/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/13/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/13/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/13/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/13/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/13/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/13/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/13/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/13/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/13/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/13/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/13/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/13/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/13/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/13/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/13/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/13/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/13/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/13/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/13/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/13/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/13/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Sanitary Sewer Construction Inspection Partial 9/16/2019 09/16/2019
Misc
Informational
09/14/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/14/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/14/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/14/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/14/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/14/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/14/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/14/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/14/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/14/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/14/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/14/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/14/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/14/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/14/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/14/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/14/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/14/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/14/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/14/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/14/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/16/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Sanitary Sewer Construction Inspection Partial 9/17/2019 09/17/2019
Misc
Informational
09/16/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/16/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/16/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/16/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/16/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/16/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/16/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/16/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/16/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/16/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/16/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/16/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/16/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/16/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/16/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/16/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/16/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/16/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/16/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/16/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/16/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/16/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/16/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/16/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/16/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/16/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/16/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/16/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/16/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/16/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/16/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/16/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/17/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Sanitary Sewer Construction Inspection Partial 9/18/2019 09/18/2019
Misc
Informational
09/17/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/17/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/17/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/17/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/17/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/17/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/17/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/17/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/17/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/17/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/17/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/17/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/17/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/17/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/17/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/17/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/17/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/17/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/17/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/17/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/17/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/17/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/17/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/17/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/17/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/18/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Sanitary Sewer Construction Inspection Partial 9/19/2019 09/19/2019
Misc
Informational
09/18/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/18/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/18/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/18/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/18/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/18/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/18/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/18/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/18/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/18/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/18/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/18/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/18/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/18/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/18/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/18/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/18/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/18/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/18/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/18/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/18/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/18/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/18/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/18/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/18/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/18/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/18/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/18/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/18/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/18/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/18/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/18/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/18/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/18/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/19/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Sanitary Sewer Construction Inspection Partial 9/20/2019 09/20/2019
Misc
Informational
09/19/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/19/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/19/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/19/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/19/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/19/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/19/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/19/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/19/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/19/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/19/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/19/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/19/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/19/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/19/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/19/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/19/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/19/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/19/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/19/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/19/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/19/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/19/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/19/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/19/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/19/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/19/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/20/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Sanitary Sewer Construction Inspection Partial 9/21/2019 09/21/2019
Misc
Informational
09/20/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/20/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/20/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/20/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/20/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/20/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/20/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/20/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/20/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/20/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/20/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/20/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/20/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/20/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/20/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/20/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/20/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/20/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/20/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/20/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/20/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/20/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/20/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/20/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/20/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/20/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/20/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/20/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/20/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/20/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/20/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/20/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/20/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/20/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/20/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/20/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
09/21/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Sanitary Sewer Construction Inspection Partial 9/25/2019 09/25/2019
Misc
Informational
09/21/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/21/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/21/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/21/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/21/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/21/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/21/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/21/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/21/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/21/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/21/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/21/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/21/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/21/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/21/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/21/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/21/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/21/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/21/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/21/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/21/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/21/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/21/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/21/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/21/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/21/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/21/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/21/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
09/21/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
09/25/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Sanitary Sewer Construction Inspection Partial 9/26/2019 09/26/2019
Misc
Informational
09/25/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/25/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/25/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/25/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/25/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/25/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/25/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/25/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/25/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/25/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/25/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/25/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/25/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/25/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/25/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/25/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/25/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/25/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/25/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/25/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/25/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/25/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/25/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/25/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/25/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/25/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/25/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/25/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/25/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/25/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/25/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/25/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/25/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/25/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/25/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/25/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
09/25/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
09/25/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
09/26/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Sanitary Sewer Construction Inspection Partial 10/1/2019 10/01/2019
Misc
Informational
09/30/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/30/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/30/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/30/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/30/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/30/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/30/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/30/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/30/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/30/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/30/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/30/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/30/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/30/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/30/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/30/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/30/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/30/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/30/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/30/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/30/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/30/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/30/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/30/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/30/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/30/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/30/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/30/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/30/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/30/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/30/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/30/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/30/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/30/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/30/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/30/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
09/30/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
09/30/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
09/30/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
09/30/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/01/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Sanitary Sewer Construction Inspection Partial 10/2/2019 10/02/2019
Misc
Informational
09/26/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
09/26/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
09/26/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
09/26/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
09/26/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
09/26/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
09/26/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
09/26/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
09/26/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
09/26/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
09/26/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
09/26/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
09/26/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
09/26/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
09/26/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
09/26/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/26/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/26/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/26/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/26/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/26/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/26/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
09/26/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
09/26/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
09/26/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
09/26/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
09/26/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
09/26/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
09/26/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
09/26/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
09/26/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
09/26/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
09/26/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
09/26/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
09/26/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
09/26/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
09/26/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
09/26/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
09/26/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
09/27/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/02/2019
10-2-19 9:14am manhole A-5 is set and backfilled. They will continuing out of A-5 with sanitary line today. 2:23pm They have no like me installed. They did pour A-4 invert.
Sanitary Sewer Construction Inspection Partial 10/4/2019 10/04/2019
Misc
Informational
10/02/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/02/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/02/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/02/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/02/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/02/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/02/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/02/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/02/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/02/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/02/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/02/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/02/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/02/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/02/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/02/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/02/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/02/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/02/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/02/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/02/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/02/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/02/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/02/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/02/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/02/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/02/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/02/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/02/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/02/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/02/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/02/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/02/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/02/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/02/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/02/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/02/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/02/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/02/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/02/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/02/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/04/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Sanitary Sewer Construction Inspection Partial 10/7/2019 10/07/2019
Misc
Informational
10/04/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/04/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/04/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/04/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/04/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/04/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/04/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/04/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/04/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/04/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/04/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/04/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/04/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/04/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/04/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/04/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/04/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/04/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/04/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/04/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/04/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/04/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/04/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/04/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/04/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/04/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/04/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/04/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/04/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/04/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/04/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/04/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/07/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Sanitary Sewer Construction Inspection Partial 10/07/2019
Misc
Informational
10/07/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/07/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/07/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/07/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/07/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/07/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/07/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/07/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/07/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/07/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/07/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/07/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/07/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/07/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/07/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/07/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/07/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/07/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/07/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/07/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/07/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/07/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/07/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/07/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/07/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/07/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/07/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/07/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/07/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/07/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/07/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/07/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/07/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/07/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/07/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Sanitary Sewer Construction Inspection Partial 10/8/2019 10/08/2019
Misc
Informational
10/07/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/07/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/07/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/07/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/07/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/07/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/07/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/07/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/07/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/07/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/07/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/07/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/07/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/07/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/07/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/07/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/07/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/07/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/07/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/07/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/07/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/07/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/07/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/07/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/07/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/07/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/07/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/07/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/07/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/07/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/07/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/07/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/07/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/07/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/07/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/07/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/07/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/08/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Sanitary Sewer Construction Inspection Partial 10/9/2019 10/09/2019
Misc
Informational
10/08/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/08/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/08/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/08/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/08/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/08/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/08/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/08/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/08/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/08/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/08/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/08/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/08/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/08/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/08/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/08/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/08/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/08/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/08/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/08/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/08/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/08/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/08/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/08/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/08/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/08/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/08/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/08/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/08/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/08/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/08/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/08/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/08/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/08/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/08/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/08/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/08/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/08/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/08/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/08/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/08/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/08/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/08/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/08/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/08/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/09/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Sanitary Sewer Construction Inspection Partial 10/14/2019 10/14/2019
Misc
Informational
10/09/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/09/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/09/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/09/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/09/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/09/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/09/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/09/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/09/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/09/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/09/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/09/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/09/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/09/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/09/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/09/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/09/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/09/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/09/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/09/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/09/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/09/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/09/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/09/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/09/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/09/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/09/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/09/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/09/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/09/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/09/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/09/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/09/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/09/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/09/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/09/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/09/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/09/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/09/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/09/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/14/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Sanitary Sewer Construction Inspection Partial 10/15/2019 10/15/2019
Misc
Informational
10/14/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/14/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/14/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/14/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/14/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/14/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/14/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/14/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/14/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/14/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/14/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/14/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/14/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/14/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/14/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/14/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/14/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/14/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/14/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/14/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/14/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/14/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/14/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/14/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/14/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/14/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/14/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/14/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/14/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/14/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/14/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/14/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/14/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/14/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/14/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/14/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/14/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/14/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/14/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/14/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
10/15/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Sanitary Sewer Construction Inspection Partial 10/17/2019 10/17/2019
Misc
Informational
10/15/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/15/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/15/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/15/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/15/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/15/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/15/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/15/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/15/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/15/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/15/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/15/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/15/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/15/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/15/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/15/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/15/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/15/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/15/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/15/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/15/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/15/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/15/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/15/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/15/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/15/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/15/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/15/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/15/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/15/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/15/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/15/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/15/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/15/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/15/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/15/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/15/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/15/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/15/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/15/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/15/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/15/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/15/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/15/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/15/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/15/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/15/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
10/15/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
10/17/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Sanitary Sewer Construction Inspection Partial 10/21/2019 10/21/2019
Misc
Informational
10/17/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/17/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/17/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/17/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/17/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/17/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/17/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/17/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/17/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/17/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/17/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/17/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/17/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/17/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/17/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/17/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/17/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/17/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/17/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/17/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/17/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/17/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/17/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/17/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/17/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/17/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/17/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/17/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/17/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/17/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/17/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/17/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/17/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/17/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/17/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/17/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/17/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/17/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/17/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/17/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/17/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
10/17/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
10/17/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
10/21/2019
10-18-19 They have tied into A-7 and are backfilling.
Sanitary Sewer - Mandrel Partial 10/24/2019 10/24/2019
Misc
Corrective Action Required
09/09/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
09/09/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
09/09/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
10/24/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed.
Sanitary Sewer - Vacuum Partial 10/24/2019 10/24/2019
Misc
Informational
09/09/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
09/09/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
09/09/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
09/09/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
10/24/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Sanitary Sewer - Air Test Partial 10/24/2019 10/24/2019
Misc
Informational
09/09/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
09/09/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
09/09/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
10/24/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Sanitary Sewer - Mandrel Partial 10/24/2019 10/24/2019
Misc
Corrective Action Required
10/24/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
10/24/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
10/24/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
10/24/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed. 1:28pm They are now preparing to pull the mandrel from A15 to A14. The mandrel pass from A15 to A14 and from A14 to A13.
Sanitary Sewer - Vacuum Partial 10/24/2019 10/24/2019
Misc
Informational
10/24/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
10/24/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
10/24/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
10/24/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
10/24/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
10/24/2019
10-24-19 The vacuum test on manhole A15 has passed.
Sanitary Sewer - Air Test Partial 10/24/2019 10/25/2019
Misc
Informational
10/24/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
10/24/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
10/24/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
10/24/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Sanitary Sewer - Air Test Partial 10/25/2019 10/25/2019
Misc
Informational
10/25/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
10/25/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
10/25/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
10/25/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Misc
Informational
10/25/2019
10-25-19 We are testing from A10 to D2. A10 to D1 and D2 has passed the air test.
Sanitary Sewer - Vacuum Partial 10/25/2019 10/25/2019
Misc
Informational
10/24/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
10/24/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
10/24/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
10/24/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
10/24/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
10/24/2019
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
10/25/2019
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Sanitary Sewer - Mandrel Partial 10/25/2019 10/25/2019
Misc
Corrective Action Required
10/24/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
10/24/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
10/24/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
10/24/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed. 1:28pm They are now preparing to pull the mandrel from A15 to A14. The mandrel pass from A15 to A14 and from A14 to A13.
Misc
Informational
10/25/2019
10-25-19 3:09pm From D2 to D1 the mandrel has passed. From D2 to D1 has passed.4:01pm From A9 to A8 passed and from A8 to A7 passed.
Sanitary Sewer Construction Inspection Partial 10/28/2019 10/28/2019
Misc
Informational
10/21/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/21/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/21/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/21/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/21/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/21/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/21/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/21/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/21/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/21/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/21/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/21/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/21/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/21/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/21/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/21/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/21/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/21/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/21/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/21/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/21/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/21/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/21/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/21/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/21/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/21/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/21/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/21/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/21/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/21/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/21/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/21/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/21/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/21/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/21/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/21/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/21/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/21/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/21/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/21/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/21/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
10/21/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
10/21/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
10/21/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
10/28/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Sanitary Sewer Construction Inspection Partial 11/05/2019
Misc
Informational
10/28/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
10/28/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
10/28/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
10/28/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
10/28/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
10/28/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
10/28/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
10/28/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
10/28/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
10/28/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
10/28/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
10/28/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
10/28/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
10/28/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
10/28/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
10/28/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/28/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/28/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/28/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/28/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/28/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/28/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
10/28/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
10/28/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
10/28/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
10/28/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
10/28/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
10/28/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
10/28/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
10/28/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
10/28/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
10/28/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
10/28/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
10/28/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
10/28/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
10/28/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
10/28/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
10/28/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
10/28/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
10/28/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
10/28/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
10/28/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
10/28/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
10/28/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
10/28/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
10/28/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
10/28/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
10/28/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
10/28/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
10/28/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
10/28/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
11/05/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Sanitary Sewer Construction Inspection Partial 11/19/2019 11/19/2019
Misc
Informational
11/05/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
11/05/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
11/05/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
11/05/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
11/05/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
11/05/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
11/05/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
11/05/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
11/05/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
11/05/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
11/05/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
11/05/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
11/05/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
11/05/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
11/05/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
11/05/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/05/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/05/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/05/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/05/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/05/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/05/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/05/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/05/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
11/05/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
11/05/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
11/05/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
11/05/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
11/05/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
11/05/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
11/05/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
11/05/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
11/05/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
11/05/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
11/05/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
11/05/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
11/05/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
11/05/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
11/05/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
11/05/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
11/05/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
11/05/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
11/05/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
11/05/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
11/05/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
11/05/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
11/05/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
11/05/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
11/05/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
11/05/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
11/05/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
11/05/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
11/19/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Sanitary Sewer Construction Inspection Partial 11/22/2019 11/23/2019
Misc
Informational
11/19/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
11/19/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
11/19/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
11/19/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
11/19/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
11/19/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
11/19/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
11/19/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
11/19/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
11/19/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
11/19/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
11/19/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
11/19/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
11/19/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
11/19/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
11/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/19/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/19/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/19/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
11/19/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
11/19/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
11/19/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
11/19/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
11/19/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
11/19/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
11/19/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
11/19/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
11/19/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
11/19/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
11/19/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
11/19/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
11/19/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
11/19/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
11/19/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
11/19/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
11/19/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
11/19/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
11/19/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
11/19/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
11/19/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
11/19/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
11/19/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
11/19/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
11/19/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
11/19/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
11/19/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
11/19/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
11/19/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
11/23/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Sanitary Sewer Construction Inspection Partial 12/04/2019
Misc
Informational
11/23/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
11/23/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
11/23/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
11/23/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
11/23/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
11/23/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
11/23/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
11/23/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
11/23/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
11/23/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
11/23/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
11/23/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
11/23/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
11/23/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
11/23/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
11/23/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/23/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/23/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/23/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/23/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/23/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/23/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
11/23/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
11/23/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
11/23/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
11/23/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
11/23/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
11/23/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
11/23/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
11/23/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
11/23/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
11/23/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
11/23/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
11/23/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
11/23/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
11/23/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
11/23/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
11/23/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
11/23/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
11/23/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
11/23/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
11/23/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
11/23/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
11/23/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
11/23/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
11/23/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
11/23/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
11/23/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
11/23/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
11/23/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
11/23/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
11/23/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
11/23/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
11/23/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
12/02/2019
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
12/04/2019
12-3-19 They are still trying to make the corrections to the sags at A-11.
Sanitary Sewer Construction Inspection Partial 12/4/2019 12/04/2019
Misc
Informational
12/04/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
12/04/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
12/04/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
12/04/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
12/04/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
12/04/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
12/04/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
12/04/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
12/04/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
12/04/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
12/04/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
12/04/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
12/04/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
12/04/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
12/04/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
12/04/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
12/04/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
12/04/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
12/04/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
12/04/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
12/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
12/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
12/04/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
12/04/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
12/04/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
12/04/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
12/04/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
12/04/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
12/04/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
12/04/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
12/04/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
12/04/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
12/04/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
12/04/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
12/04/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
12/04/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
12/04/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
12/04/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
12/04/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
12/04/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
12/04/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
12/04/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
12/04/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
12/04/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
12/04/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
12/04/2019
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
12/04/2019
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
12/04/2019
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Sanitary Sewer - Mandrel Partial 12/5/2019 12/05/2019
Misc
Corrective Action Required
10/25/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
10/25/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
10/25/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
10/25/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed. 1:28pm They are now preparing to pull the mandrel from A15 to A14. The mandrel pass from A15 to A14 and from A14 to A13.
Misc
Informational
10/25/2019
10-25-19 3:09pm From D2 to D1 the mandrel has passed. From D2 to D1 has passed.4:01pm From A9 to A8 passed and from A8 to A7 passed.
Misc
Informational
12/05/2019
12-5-19 8:50am The mandrel has passed from A1 to A2. It has passed from A2 to A3. It has passed from A3 to A4. It has passed from A4 to A5. It has passed from A5 to A6. It has passed from A6 to A7. All of the inverts appear to be good.
Sanitary Sewer - Air Test Partial 12/5/2019 12/06/2019
Misc
Informational
10/25/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
10/25/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
10/25/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
10/25/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Misc
Informational
10/25/2019
10-25-19 We are testing from A10 to D2. A10 to D1 and D2 has passed the air test.
Misc
Informational
12/06/2019
12-4-19 12:50pm The air test passed from A1 to A7 except for A5 to A6, it did not pass. I inspected A3 to A4. John Jackson inspected the rest. John worked past 4pm on site and timed out at 5pm.
Sanitary Sewer Construction Inspection Partial 12/6/2019 12/06/2019
Misc
Informational
12/04/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
12/04/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
12/04/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
12/04/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
12/04/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
12/04/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
12/04/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
12/04/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
12/04/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
12/04/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
12/04/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
12/04/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
12/04/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
12/04/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
12/04/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/04/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/04/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
12/04/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
12/04/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
12/04/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
12/04/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
12/04/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
12/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
12/04/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
12/04/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
12/04/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
12/04/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
12/04/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
12/04/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
12/04/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
12/04/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
12/04/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
12/04/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
12/04/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
12/04/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
12/04/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
12/04/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
12/04/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
12/04/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
12/04/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
12/04/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
12/04/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
12/04/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
12/04/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
12/04/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
12/04/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
12/04/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
12/04/2019
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
12/04/2019
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
12/04/2019
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
12/05/2019
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
12/06/2019
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Sanitary Sewer - Mandrel Failed 12/10/2019 12/10/2019
Misc
Corrective Action Required
12/05/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
12/05/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
12/05/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
12/05/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed. 1:28pm They are now preparing to pull the mandrel from A15 to A14. The mandrel pass from A15 to A14 and from A14 to A13.
Misc
Informational
12/05/2019
10-25-19 3:09pm From D2 to D1 the mandrel has passed. From D2 to D1 has passed.4:01pm From A9 to A8 passed and from A8 to A7 passed.
Misc
Informational
12/05/2019
12-5-19 8:50am The mandrel has passed from A1 to A2. It has passed from A2 to A3. It has passed from A3 to A4. It has passed from A4 to A5. It has passed from A5 to A6. It has passed from A6 to A7. All of the inverts appear to be good.
Misc
Informational
12/10/2019
12-10-19 12:57pm They are pulling the mandrel from C1 to B1. 1:10pm The mandrel test has failed. The mandrel is stuck in the pipe approximately 8ft away from manhole C1.
Sanitary Sewer - Vacuum Failed 12/10/2019 12/10/2019
Misc
Informational
10/25/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
10/25/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
10/25/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
10/25/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
10/25/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
10/25/2019
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
10/25/2019
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Misc
Informational
12/10/2019
12-10-19 1:31pm They are setting up the vacuum test for manhole C1. 2:15pm The vacuum test failed. They will need to make corrections.
Sanitary Sewer - Vacuum Partial 12/10/2019 at 4:00 AM 12/11/2019
Misc
Informational
12/10/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
12/10/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
12/10/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
12/10/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
12/10/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
12/10/2019
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
12/10/2019
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Misc
Informational
12/10/2019
12-10-19 1:31pm They are setting up the vacuum test for manhole C1. 2:15pm The vacuum test failed. They will need to make corrections.
Informational
12/11/2019
MH A2 thur A7 passed Vacuum test. MH A1 is the existing MH.
Sanitary Sewer - Air Test Failed 12/10/2019 at 3:30 AM 12/11/2019
Misc
Informational
12/06/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
12/06/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
12/06/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
12/06/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Misc
Informational
12/06/2019
10-25-19 We are testing from A10 to D2. A10 to D1 and D2 has passed the air test.
Misc
Informational
12/06/2019
12-4-19 12:50pm The air test passed from A1 to A7 except for A5 to A6, it did not pass. I inspected A3 to A4. John Jackson inspected the rest. John worked past 4pm on site and timed out at 5pm.
Corrective Action Required
12/11/2019
Air Test Failed From A4 to A5 contractor will continue trying to resolve issue. John M. Jackson onsite to observe and report test results. Rapid pressures loss after less than a minute of start time.
Sanitary Sewer - Vacuum Partial 12/11/2019
Misc
Informational
12/11/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
12/11/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
12/11/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
12/11/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
12/11/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
12/11/2019
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
12/11/2019
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Misc
Informational
12/11/2019
12-11-19 9:32am The C1 manhole has passed the vacuum test.
Sanitary Sewer Construction Inspection Partial 12/31/2019
Misc
Informational
12/06/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
12/06/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
12/06/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
12/06/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
12/06/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
12/06/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
12/06/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
12/06/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
12/06/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
12/06/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
12/06/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
12/06/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
12/06/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
12/06/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
12/06/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
12/06/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
12/06/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
12/06/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
12/06/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
12/06/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
12/06/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
12/06/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
12/06/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
12/06/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
12/06/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
12/06/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
12/06/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
12/06/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
12/06/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
12/06/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
12/06/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
12/06/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
12/06/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/06/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/06/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/06/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/06/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/06/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/06/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/06/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/06/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
12/06/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
12/06/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
12/06/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
12/06/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
12/06/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
12/06/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
12/06/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
12/06/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
12/06/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
12/06/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
12/06/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
12/06/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
12/06/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
12/06/2019
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
12/06/2019
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
12/06/2019
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
12/06/2019
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
12/06/2019
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
12/31/2019
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Sanitary Sewer - Mandrel Passed 1/6/2020 01/06/2020
Misc
Corrective Action Required
12/10/2019
Bill from ESS performed the mandrel test on the following sanitary lines. The mandrel was the correct size for the 8 inch line 7.37 inches. MHA9 to MHA10, MHA10 to MHA11, MHA11 to MHA12, MHA11 to MHG1 all passed. MHA10 to MHD1 failed the test. It appears that the sanitary pipe is crushed about 7 feet from MHA10. Bill and Rudy are aware of the failure of this sanitary line. RP 9-3-19
Misc
Informational
12/10/2019
9-4-19 They pulled the mandrel from A-12 to A-11. It passed. They pulled the mandrel from T-30 to C-1
Misc
Informational
12/10/2019
9-9-19 9:32am They are setting up at A12 to pull the material to A-13. The mandrel passed from A-12 to A-13. 9:46am They are pulling from A-13 to A-14. 9:58am The mandrel did not make it through A-13 to A-14.
Misc
Informational
12/10/2019
10-24-19 10:40am They are pulling the mandrel from B1 to C1. It did not pass.The mandrel got stuck approximately 6ft from C1. They pulled the mandrel from C2 to C1, it passed. 1:28pm They are now preparing to pull the mandrel from A15 to A14. The mandrel pass from A15 to A14 and from A14 to A13.
Misc
Informational
12/10/2019
10-25-19 3:09pm From D2 to D1 the mandrel has passed. From D2 to D1 has passed.4:01pm From A9 to A8 passed and from A8 to A7 passed.
Misc
Informational
12/10/2019
12-5-19 8:50am The mandrel has passed from A1 to A2. It has passed from A2 to A3. It has passed from A3 to A4. It has passed from A4 to A5. It has passed from A5 to A6. It has passed from A6 to A7. All of the inverts appear to be good.
Misc
Informational
12/10/2019
12-10-19 12:57pm They are pulling the mandrel from C1 to B1. 1:10pm The mandrel test has failed. The mandrel is stuck in the pipe approximately 8ft away from manhole C1.
Misc
Informational
01/06/2020
1-6-2020 The mandrel is 7.37. They are pulling from A12 manhole to A11. I has passed from A12 to A11. They are now pulling from A11 to A10. 2:02pm The mandrel has passed from A11 to A10.
Sanitary Sewer - Air Test Passed 1/6/2020 01/06/2020
Misc
Informational
12/11/2019
Bill from ESS performed the air test for the following sanitary lines. Gauges were calibrated within the last year. MHA9 to MHA10, MH A10 to MHA11, MHA10 to MHD1 and MHA11 to MHG1 all passed. We couldn’t perform any further testing due to 2 broken gauges. RP 9-3-19
Misc
Informational
12/11/2019
9-4-19 They are testing from A-7 to A-8 269 feet. A-7 to A-8 has passed. We are now setting up for A-8 to A-9. A-8 to A-9 has passed. 1:28pm we are testing from A-11 to A12. It has passed, it held for 7:34 at 4psig. 2:59pm We are testing from E-1 to T-32. It has passed.5:14pm We are testing E-2 to E-1. E-1 to E-2 passed.
Misc
Informational
12/11/2019
9-9-19 8:18am They are setting up for the air test for A-12 to A-14 The air test has passed for A-12 ton A-14.
Misc
Informational
12/11/2019
10-24-19 10:01am We are testing from C-1 to B-1 at the north east end of the site. The gauge being used is certified. The line has passed, it held for 7:34 min:s at 4 psig. 10:22am We are now setting up for the air test from C1 to C2. This will be a 10 minute air test. C1 to C2 has passed. 2:04pm They are setting up to air test between A14 to A15. A14 to A15 has passed.
Misc
Informational
12/11/2019
10-25-19 We are testing from A10 to D2. A10 to D1 and D2 has passed the air test.
Misc
Informational
01/06/2020
1-6-2020 2:24pm We are testing from manhole A10 to A11. The air test has passed.
Sanitary Sewer - Vacuum Failed 1/6/2020 01/06/2020
Misc
Informational
12/11/2019
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
12/11/2019
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
12/11/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
12/11/2019
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
12/11/2019
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
12/11/2019
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
12/11/2019
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Misc
Informational
12/11/2019
12-11-19 9:32am The C1 manhole has passed the vacuum test.
Misc
Informational
01/06/2020
1-6-2020 3:01pm We are testing manhole A11. Manhole A11 did not pass.
Sanitary Sewer - Vacuum Passed 1/7/2020 01/07/2020
Misc
Informational
01/06/2020
Bill from ESS performed the vacuum test on the following sanitary man holes. The gauge was calibrated within the last year. MHA9, MHA10, MHA11, MHD1, MHG1 all passed. RP 9-3-19
Misc
Informational
01/06/2020
9-4-19 10:14am They are setting up to do a vacuum test on manhole A-8. This test will take 2.5 min..10:26 It has passed the vacuum test for A-8. 1:44pm They are setting up for the vacuum test for A-12. A-12 passed it held for the required time. C-1 manhole has failed the vacuum test. They are going to set up on E-2. E-2 has passed.
Misc
Informational
01/06/2020
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14.
Misc
Informational
01/06/2020
9-9-19 8:54am They are setting up for Vacuum test on A-13 and A-14. 9:13am A-13 has passed vacuum. 9:30am A-14 has passed vacuum.
Misc
Informational
01/06/2020
10-24-19 12:55pm The vacuum held on manhole B1. 1:05pm We are testing C2. It has passed.
Misc
Informational
01/06/2020
10-24-19 The vacuum test on manhole A15 has passed.
Misc
Informational
01/06/2020
10-25-19 2:33pm The vacuum test on D1 has passed. The vacuum test on D2 has passed.
Misc
Informational
01/06/2020
12-11-19 9:32am The C1 manhole has passed the vacuum test.
Misc
Informational
01/06/2020
1-6-2020 3:01pm We are testing manhole A11. Manhole A11 did not pass.
Misc
Informational
01/07/2020
1-7-2020 2:00pm The vacuum test for A11 has passed.
Sanitary Sewer Construction Inspection Partial 1/8/2020 01/08/2020
Misc
Informational
12/31/2019
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
12/31/2019
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
12/31/2019
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
12/31/2019
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
12/31/2019
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
12/31/2019
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
12/31/2019
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
12/31/2019
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
12/31/2019
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
12/31/2019
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
12/31/2019
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
12/31/2019
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
12/31/2019
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
12/31/2019
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
12/31/2019
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
12/31/2019
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
12/31/2019
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
12/31/2019
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
12/31/2019
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
12/31/2019
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
12/31/2019
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
12/31/2019
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
12/31/2019
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
12/31/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
12/31/2019
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
12/31/2019
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
12/31/2019
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
12/31/2019
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
12/31/2019
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
12/31/2019
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
12/31/2019
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
12/31/2019
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
12/31/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/31/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/31/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/31/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/31/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/31/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/31/2019
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
12/31/2019
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
12/31/2019
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
12/31/2019
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
12/31/2019
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
12/31/2019
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
12/31/2019
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
12/31/2019
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
12/31/2019
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
12/31/2019
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
12/31/2019
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
12/31/2019
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
12/31/2019
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
12/31/2019
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
12/31/2019
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
12/31/2019
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
12/31/2019
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
12/31/2019
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
12/31/2019
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
12/31/2019
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
12/31/2019
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
12/31/2019
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
01/08/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Sanitary Sewer Construction Inspection Partial 1/9/2020 01/09/2020
Misc
Informational
01/08/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
01/08/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
01/08/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
01/08/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
01/08/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
01/08/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
01/08/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
01/08/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
01/08/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
01/08/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
01/08/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
01/08/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
01/08/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
01/08/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
01/08/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
01/08/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
01/08/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
01/08/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
01/08/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
01/08/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
01/08/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
01/08/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
01/08/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
01/08/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
01/08/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
01/08/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
01/08/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
01/08/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
01/08/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
01/08/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
01/08/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
01/08/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
01/08/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/08/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/08/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/08/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/08/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/08/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/08/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/08/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/08/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
01/08/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
01/08/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
01/08/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
01/08/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
01/08/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
01/08/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
01/08/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
01/08/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
01/08/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
01/08/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
01/08/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
01/08/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
01/08/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
01/08/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
01/08/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
01/08/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
01/08/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
01/08/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
01/08/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
01/08/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
01/09/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Sanitary Sewer Construction Inspection Partial 01/15/2020
Misc
Informational
01/09/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
01/09/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
01/09/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
01/09/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
01/09/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
01/09/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
01/09/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
01/09/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
01/09/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
01/09/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
01/09/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
01/09/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
01/09/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
01/09/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
01/09/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
01/09/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
01/09/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
01/09/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/09/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/09/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/09/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/09/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/09/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/09/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/09/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/09/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
01/09/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
01/09/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
01/09/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
01/09/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
01/09/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
01/09/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
01/09/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
01/09/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
01/09/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
01/09/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
01/09/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
01/09/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
01/09/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
01/09/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
01/09/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
01/09/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
01/09/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
01/09/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
01/09/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
01/09/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
01/09/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
01/09/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
01/09/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
01/09/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
01/09/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
01/09/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
01/09/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
01/09/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
01/09/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
01/09/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
01/09/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
01/09/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
01/09/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
01/09/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
01/09/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
01/09/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
01/15/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Sanitary Sewer Construction Inspection Partial 1/22/2020 01/23/2020
Misc
Informational
01/15/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
01/15/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
01/15/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
01/15/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
01/15/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
01/15/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
01/15/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
01/15/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
01/15/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
01/15/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
01/15/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
01/15/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
01/15/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
01/15/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
01/15/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
01/15/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
01/15/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
01/15/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/15/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/15/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/15/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/15/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/15/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/15/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/15/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/15/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
01/15/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
01/15/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
01/15/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
01/15/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
01/15/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
01/15/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
01/15/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
01/15/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
01/15/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
01/15/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
01/15/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
01/15/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
01/15/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
01/15/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
01/15/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
01/15/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
01/15/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
01/15/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
01/15/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
01/15/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
01/15/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
01/15/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
01/15/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
01/15/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
01/15/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
01/15/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
01/15/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
01/15/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
01/15/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
01/15/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
01/15/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
01/15/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
01/15/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
01/15/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
01/15/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
01/15/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
01/15/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Misc
Informational
01/23/2020
Joe Starlin 01/23/2020 7:25 AM The water department said that there are still two sags at A-4 and A-6. I have emailed and called Hal with ESS about this.
Sanitary Sewer Construction Inspection Partial 2/17/2020 02/17/2020
Misc
Informational
01/23/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
01/23/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
01/23/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
01/23/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
01/23/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
01/23/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
01/23/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
01/23/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
01/23/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
01/23/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
01/23/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
01/23/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
01/23/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
01/23/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
01/23/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
01/23/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
01/23/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
01/23/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/23/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/23/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/23/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/23/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/23/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/23/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
01/23/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
01/23/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
01/23/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
01/23/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
01/23/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
01/23/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
01/23/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
01/23/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
01/23/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
01/23/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
01/23/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
01/23/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
01/23/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
01/23/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
01/23/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
01/23/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
01/23/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
01/23/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
01/23/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
01/23/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
01/23/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
01/23/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
01/23/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
01/23/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
01/23/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
01/23/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
01/23/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
01/23/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
01/23/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
01/23/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
01/23/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
01/23/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
01/23/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
01/23/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
01/23/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
01/23/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
01/23/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
01/23/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
01/23/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Misc
Informational
01/23/2020
Joe Starlin 01/23/2020 7:25 AM The water department said that there is still two sags at A-4 and A-6. I have emailed and called Hal with ESS about this.
Misc
Informational
02/11/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-17-20 9:14am
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-17-20 9:14am They have one sag corrected and are working on the second one.
Sanitary Sewer Construction Inspection Partial 02/18/2020
Misc
Informational
02/17/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
02/17/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
02/17/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
02/17/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
02/17/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
02/17/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
02/17/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
02/17/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
02/17/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
02/17/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
02/17/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
02/17/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
02/17/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
02/17/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
02/17/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
02/17/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
02/17/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
02/17/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/17/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/17/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/17/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/17/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/17/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/17/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/17/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/17/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
02/17/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
02/17/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
02/17/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
02/17/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
02/17/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
02/17/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
02/17/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
02/17/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
02/17/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
02/17/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
02/17/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
02/17/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
02/17/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
02/17/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
02/17/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
02/17/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
02/17/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
02/17/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
02/17/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
02/17/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
02/17/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
02/17/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
02/17/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
02/17/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
02/17/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
02/17/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
02/17/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
02/17/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
02/17/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
02/17/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
02/17/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
02/17/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
02/17/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
02/17/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
02/17/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
02/17/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
02/17/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Misc
Informational
02/17/2020
Joe Starlin 01/23/2020 7:25 AM The water department said that there is still two sags at A-4 and A-6. I have emailed and called Hal with ESS about this.
Misc
Informational
02/17/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Resolved
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Resolved
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Resolved
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Resolved
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/17/2020
2-17-20 9:14am They have fix one of the two sags and are working on the second one.
Misc
Resolved
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Resolved
02/18/2020
2-17-20 9:14am They have one sag corrected and are working on the second one.
Sanitary Sewer Construction Inspection Partial 02/18/2020
Misc
Informational
02/18/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
02/18/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
02/18/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
02/18/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
02/18/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
02/18/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
02/18/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
02/18/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
02/18/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
02/18/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
02/18/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
02/18/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
02/18/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
02/18/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
02/18/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
02/18/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
02/18/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
02/18/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
02/18/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
02/18/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
02/18/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
02/18/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
02/18/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
02/18/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
02/18/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
02/18/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
02/18/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
02/18/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
02/18/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
02/18/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
02/18/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
02/18/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
02/18/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
02/18/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
02/18/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
02/18/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
02/18/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
02/18/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
02/18/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
02/18/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
02/18/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
02/18/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
02/18/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
02/18/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
02/18/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
02/18/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
02/18/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
02/18/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
02/18/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
02/18/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
02/18/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
02/18/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
02/18/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
02/18/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Misc
Informational
02/18/2020
Joe Starlin 01/23/2020 7:25 AM The water department said that there is still two sags at A-4 and A-6. I have emailed and called Hal with ESS about this.
Misc
Informational
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/18/2020
2-17-20 9:14am They have fix one of the two sags and are working on the second one. 2-18-20 9:31am They have made corrections to both sags on the sanitary line. The 30 day clock starts on 2-13-20 and 2-18-20.
Sanitary Sewer Construction Inspection Partial 02/18/2020
Misc
Informational
02/18/2020
9-18-19. They are still breaking rock. They installed 42 feet total on 9-17-19 They are working on placing a stick and A-4 manhole today. I talked with Dave about service lines and told him to follow the detail. 1:20pm They are still breaking rock for the manhole.
Misc
Informational
02/18/2020
10-1-19 8:19am They did not get to A-5 manhole. They are working on cleaning up and pumping water. They have approximately 21 feet of pipe and manhole A-5. They are setting the barrels for manhole A5. When it is set they are going to backfill and prep for possible rains showers.
Misc
Informational
02/18/2020
10-4-19 They have installed one stick of pipe and wye. They have stoped work to do a repair on a service line.
Misc
Informational
02/18/2020
10-7-19 12:10pm They are getting ready to place there 4th stick of sanitary line out of A5.
Misc
Informational
02/18/2020
10-7-19 2:24pm The are having trouble with there equipment. At this time they have not installed anymore sanitary line.
Misc
Informational
02/18/2020
9-11-19 They have approximately 24 feet of sanitary line installed up to manhole A-2. 3:14pm They have installed 24 feet of sanitary line out of A-2 working for A-3.
Misc
Informational
02/18/2020
9-12-19 They have back filled 56 feet of pipe. I told them they need to get sanitary tape in and set up erosion control were there working. Dave said they would get it taken care of. 2:25pm mulch burm is in place gutter buddy is installed and they have manhole A-3 set. Rain is moving in.
Misc
Informational
02/18/2020
9-13-19 9:14am They have 42 feet of sanitary line installed. 2:40PM They have approximately 100 feet of sanitary line installed. They have hit more rock.
Misc
Informational
02/18/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock.
Misc
Informational
02/18/2020
Rudy’s crew laid 200 feet of sanitary pipe and set manhole D1. RP 7-15-19
Misc
Informational
02/18/2020
Rudy’s crew from ESS so far has laid 1,100 feet of sanitary pipe. They have set manholes A7, A8, A9, A10, A11 A12 and G1. They will be starting on D line next week. RP 7-13-19
Misc
Informational
02/18/2020
8-13-19 The crew had to repair a lateral for a house that was damaged during tree clearing.
Misc
Informational
02/18/2020
8-15-19 They are installing sanitary line out of C-1 heading to C-2. 10:50am They now have a total of 4 sticks installed approximately 56 feet. 2:50pm They now have a total of 8 sticks in heading to C-2.
Misc
Informational
02/18/2020
8-16-19 They have placed 56 feet of sanitary line today.
Misc
Informational
02/18/2020
8-19-19 10:00am They have one stick of sanitary line in, they are breaking rock. 12:55pm They have 56 feet of sanitary line installed. 2:02pm They are installing one stick of pipe and are still breaking rock.
Misc
Informational
02/18/2020
8-20-19 8:30am They are breaking rock to place C-2 manhole.
Misc
Informational
02/18/2020
9-21-19 light rain. They poured the inverts for C-1 C-2 and A-12.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-4-19 8:30am They are digging up sanitary line to find out why the mandrel will not go through at A-10.
Misc
Informational
02/18/2020
9-4-19 Rudy is starting at A-14 and working to A-15.
Misc
Informational
02/18/2020
9-7-19 On Friday the 6th While I was off work Rudy completed the installation of sanitary line from A-14 to A-15 and poured inverts for A-14 and A-15. 9-7-19 10:31am Rudy is pouring the invert for A-13 and will be ready for some testing on Monday the 9th.
Misc
Informational
02/18/2020
9-9-19 11:50am They pot holed a section of pipe were the mandrel got hug up. They have corrected the problem. 12:57pm There is a crew working on Chipman digging down to the sanitary line.
Misc
Informational
02/18/2020
9-14-19 7:44am They have 112 feet of sanitary line installed and are busting rock. They are getting ready to place there second stick of sanitary pipe in. They have been dealing with rock though out the digging.
Misc
Informational
02/18/2020
9-16-19 9:25am They are busting rock. No line in at this time. 1:37pm They have 14 feet of pipe installed. They may get one more stick today.
Misc
Informational
02/18/2020
10-8-19 10:41am They are busting rock and have one stick in so far today. They have a total of 5 sticks coming out of the manhole A-5 3:08pm They now have 9 sticks of sanitary line installed out of manhole A-5. They are backfilling as they go.
Misc
Informational
02/18/2020
10-9-19 10:59am They have two sticks installed at this time. Rain is moving in. It is now raining.
Misc
Informational
02/18/2020
1-14-19 8:44am They are placing there 3rd stick of sanitary line in.
Misc
Informational
02/18/2020
10-15-19 10:07am They have set manhole D2 and are digging for manhole D3. They have approximately 84 feet installed on the D line. Daves crew have A6 manhole set. They had trouble with their equipment and are now back on track with installing sanitary line to A7.
Misc
Informational
02/18/2020
9-19-19 2:04pm A-4 manhole is in and they are busting rock.
Misc
Informational
02/18/2020
9-20-19 3:21pm They installed 42 feet of sanitary line.
Misc
Informational
02/18/2020
9-21-19 They are setting up equipment for digging sanitary.10:37am They are getting ready to place there first stick of sanitary line today. Rain is forecasted for later.
Misc
Informational
02/18/2020
9-25-19They were rained out the last two days. They are getting ready to install they first wye and service line.2:39pm They have one service complete and are working on getting 42 feet installed today.
Misc
Informational
02/18/2020
9-26-19 They have a total of three sticks in from yesterday. They are dealing with dirt falling into the trench. They hope to get three sticks installed today. 2:35pm They have not installed any sanitary line today.
Misc
Informational
02/18/2020
9-27-19 9:44am They are 28 feet outside of manhole A-4 and are getting ready for manhole A-6.
Misc
Informational
02/18/2020
Rudy’s crew laid 216 feet of sanitary pipe from manhole A13 to A14. This line crosses the proposed new Lowenstein Dr. Still need to receive compaction test results for the crossing. RP 8-2-19
Misc
Informational
02/18/2020
Rudy’s crew from ESS laid 380 feet of sanitary pipe on line C. When they set manhole C1, they found out the box was made incorrectly. The line for C1 to B1 wasn’t aligned with where it needed to be. They removed manhole C1 and are waiting on a new box the be manufactured. RP 7-30-19
Misc
Informational
02/18/2020
7-29-19 10:30am Rudys crew have placed approximately 140 feet of pipe. They are placing rock and backfilling as they go. 2:30pm They have approximately 182 feet of pipe placed. They are busting rock.
Misc
Informational
02/18/2020
Rudy’s crew laid 179 feet of sanitary pipe from MH A12 to MH A13. RP 7-18-19
Misc
Informational
02/18/2020
Rudy’s crew laid 188 ft of sanitary pipe from MH D1 to D2. RP 7-17-19
Misc
Informational
02/18/2020
7-6-19 8:15am They are installing pipe from C-1 to B-1 they currently have 28 feet inbstalled plus the drop. 10:20am they are placing there 10th stick.2:55pm They have completed the sanitary line from C-1 to B-1. They have backfilled with rock and dirt. The sanitary tape has been placed as well.
Misc
Informational
02/18/2020
8-5-19 9:00am Rudy’s crew are getting ready to place manhole C-1. 3:35pm C-1 is placed and they have ran into rock.
Misc
Informational
02/18/2020
9-10-19 10:58am They are still busting rock at Chipman.
Misc
Informational
02/18/2020
9-17-191:10pm A1 and A2 inverts have been poured. They are getting ready to place there second stick of sanitary line. They are backfilling as they go along. They have sanitary tape in place.
Misc
Informational
02/18/2020
10-17-19 They have a total of 4 sticks of sanitary line coming out of A-6 working to A-7. 3:01pm They have 9 sticks out of manhole A6 now.
Misc
Informational
02/18/2020
10-18-19 They have tied into A-7 and are backfilling.
Misc
Informational
02/18/2020
10-28-19 8:48am They are cleaning up spoils from installing the sanitary line that runs through the easement A7 to A1.
Misc
Informational
02/18/2020
11-4-19 John Jackson inspected. They poured the rest of the manhole inverts.
Misc
Informational
02/18/2020
11-19-19 10:09am They are fixing the sag on A7 then will be working on A8. After A8 is fix they will move on site to fix the remaining sags. 1:41pm They are working on A8.
Misc
Informational
02/18/2020
They have the sags repaired for A7 and A8. They have not done any repairs on site.
Misc
Informational
02/18/2020
12-2-19 8:51am They are at A-11 digging up to make corrections on the sanitary line. 1:27pm They are going to grind on the invert to improve flow.
Misc
Informational
02/18/2020
12-3-19 They are still trying to make the corrections to the sags at A-11.
Misc
Informational
02/18/2020
12-4-19 9:53am They are digging up the sanitary line between A-10 and A-11 To replace the line and correct to sag. 2:55pm They are still working on replacing the sanitary line for the sag.
Misc
Informational
02/18/2020
12-5-19 7:57am They are still working on installing sanitary line between A-10 and A-11.
Miscellaneous Correction
Informational
02/18/2020
12-6-19 They completed the sanitary repair on 12-5-19. We will retest in 30 days.
Misc
Informational
02/18/2020
12-31-19 9:12am Rudy is working on cutting mastick out of the manholes.
Misc
Informational
02/18/2020
1-8-20 10:55am They are cutting out the asphalt to dig down for the sag repair at manhole C-1. The mandrel was stuck at this location. 1:59pm They have dug down to the sanitary pipe. They will be making necessary corrections and backfilling.
Misc
Informational
02/18/2020
1-9-20 They have made there repair and backfillled. We will start the 30 day clock for testing today.
Misc
Informational
02/18/2020
1-15-20 They are flushing the sanitary line to remove debris. The 30 day clock started on 1-9-20 on the north end at manhole C1.
Misc
Informational
02/18/2020
Joe Starlin 01/23/2020 7:25 AM The water department said that there is still two sags at A-4 and A-6. I have emailed and called Hal with ESS about this.
Misc
Informational
02/18/2020
2-11-20 They have started on the sanitary line to fix the two sags.
Misc
Informational
02/18/2020
2-17-20 9:14am They have fix one of the two sags and are working on the second one. 2-18-20 9:31am They have made corrections to both sags on the sanitary line. The 30 day clock starts on 2-13-20 and 2-18-20. 2-18-20 2:45pm They have pulled the mandrel from B1 to C1. It has passed.
Sanitary Sewer - Mandrel Passed 02/18/2020
Misc
Informational
02/18/2020
20-18-20 They pulled the mandrel from B1 to C1 and it has passed.
Documents & Images
Date Uploaded File Type Document Name
05/29/2019 Receipt Receipt for transaction: 2019-002949
06/14/2019 Letter DE-Permit
06/21/2019 Signed Permit
06/28/2019 Letter DE-Daily Inspection Summary
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter DE-Permit
07/11/2019 Letter INSPECTION SUMMARY
07/13/2019 Letter INSPECTION SUMMARY
07/15/2019 Letter INSPECTION SUMMARY
07/17/2019 Letter INSPECTION SUMMARY
07/18/2019 Letter INSPECTION SUMMARY
07/29/2019 Letter INSPECTION SUMMARY
08/01/2019 Letter INSPECTION SUMMARY
08/01/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY
08/05/2019 Letter INSPECTION SUMMARY
08/05/2019 Letter INSPECTION SUMMARY
08/05/2019 Manhole C-3
08/05/2019 Letter INSPECTION SUMMARY
08/06/2019 C-1 sanitary line
08/15/2019 Sanitary line
08/15/2019 Letter INSPECTION SUMMARY
08/16/2019 Letter INSPECTION SUMMARY
08/20/2019 Letter INSPECTION SUMMARY
08/20/2019 C-2 manhole
09/03/2019 Letter INSPECTION SUMMARY
09/03/2019 Letter INSPECTION SUMMARY
09/03/2019 Letter INSPECTION SUMMARY
09/04/2019 Sanitary line repair
09/04/2019 Manhole A-12
09/09/2019 Vacuum gauge certified
09/09/2019 Sanitary line A14 in road
09/11/2019 A-2 base set
09/12/2019 A line
09/12/2019 Manhole A3
09/13/2019 Letter INSPECTION SUMMARY
09/16/2019 Rock on A line
09/25/2019 Sanitary line from A6
09/26/2019 Sanitary
09/27/2019 Sanitary line 0
10/01/2019 Manhole A5
10/02/2019 A line sanitary tape
10/17/2019 Stick 9 from A6 A line
10/18/2019 Manhole A7
10/18/2019 Wye at A7
10/24/2019 C1 to B1 air test
11/23/2019 Letter DE-Daily Inspection Summary
12/11/2019 Letter INSPECTION SUMMARY
01/23/2020 Letter DE-Daily Inspection Summary
01/23/2020 scan_30155_2019-11-13-15-21-52
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
02/18/2020 Letter INSPECTION SUMMARY
04/02/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
04/02/2020 Letter DE-Punch List
07/08/2020 Receipt Receipt for transaction: 2020-004191
07/08/2020 Receipt Receipt for transaction: 2020-004191
07/08/2020 Security Document Maintenance Bond and Final Affidavit and Agreement.
06/17/2020 As-built elevations on plans
02/23/2021 7067-1SAN - as built
02/29/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
