Permit Application Status

PRSITE20203248


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSITE20203248
Development - Site
Issued
JACKSON COUNTY MISSOURI
DEVELOPMENT COMPLETE
Bridges on Paragon Pkwy
09/22/2020
09/24/2020
Locations
Contacts
JACKSON COUNTY MISSOURI, Address:415 E 12TH ST
HAPPY VALLEY PROPERTIES LLC, Address:801 NW COMMERCE DR
CITY OF LEES SUMMIT, Address:PO BOX 1600
PARAGON STAR LLC, Address:4025 NE LAKEWOOD WAY, Unit 250, Phone:(816) 207-4500
PARAGON STAR LLC, Address:801 NW COMMERCE DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 09/22/2020 09/24/2020
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C9-Water Insp Fee $11,707.20 $11,707.20 Paid 09/24/2020
9110072-Water Test Fee $400.00 $400.00 Paid 09/24/2020
9110081-Paved Surface Inspection Fee $359,954.46 $76,380.00 Paid 09/14/2021
9110068-Storm Fee $18,610.53 $18,610.53 Paid 12/05/2022
9110071-Site Grading Fee $2,132.40 $2,132.40 Paid 12/05/2022
91100C8-Sanitary Sewer Insp Fees $1,421.55 $1,421.55 Paid 12/05/2022
91100C9-Water Insp Fee $1,139.40 $1,139.40 Paid 12/05/2022
$12,846.60
8350015-Water Meter Fee $4,420.11 $4,420.11 Paid 08/26/2024
8331401-Water Tap Fee $42,380.00 $42,380.00 Paid 08/26/2024
9110081-Paved Surface Inspection Fee $283,574.46 $283,574.46 Paid 12/05/2022
$359,954.46
8331507-Sanitary Sewer Development Fee $24,381.00 $24,381.00 Paid 08/26/2024
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Punch List Inspection Pending
Water Line - Construction Inspection Partial 10/28/2020
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor has installed over 400’ of water main on Line D this was reported on PRSITE 20202246 . The Line D is connected with Line A it Tee of @ the Northside entrance of project off of View High Drive. Hydrant was installed @ Sta 03+97.31 and contractor continued to install water Line D.
Water Line - Hydrostatic Test Partial 03/04/2021
Misc
Informational
03/04/2021
3/4/21 Thursday Hydrostatic test pass on Line D from Sta 00+00 to 03+70.34.
Miscellaneous PWORKS Inspection Partial 03/09/2021
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Water Line - Construction Inspection Partial 03/09/2021
Misc
Informational
10/28/2020
10/28/20 Wednesday Contractor has installed over 400’ of water main on Line D this was reported on PRSITE 20202246 . The Line D is connected with Line A it Tee of @ the Northside entrance of project off of View High Drive. Hydrant was installed @ Sta 03+97.31 and contractor continued to install water Line D.
Misc
Informational
03/09/2021
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor Chlorinated Line A & D to 03+70 @ 2:00PM. Contractor also corrected a leak that occurred to Line A around the air relief valve ( possibly leak due to the heavy truck and equipment coming through entrance area ). All were swab with chlorine and flushed.
Miscellaneous PWORKS Inspection Partial 03/10/2021
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/10/2021

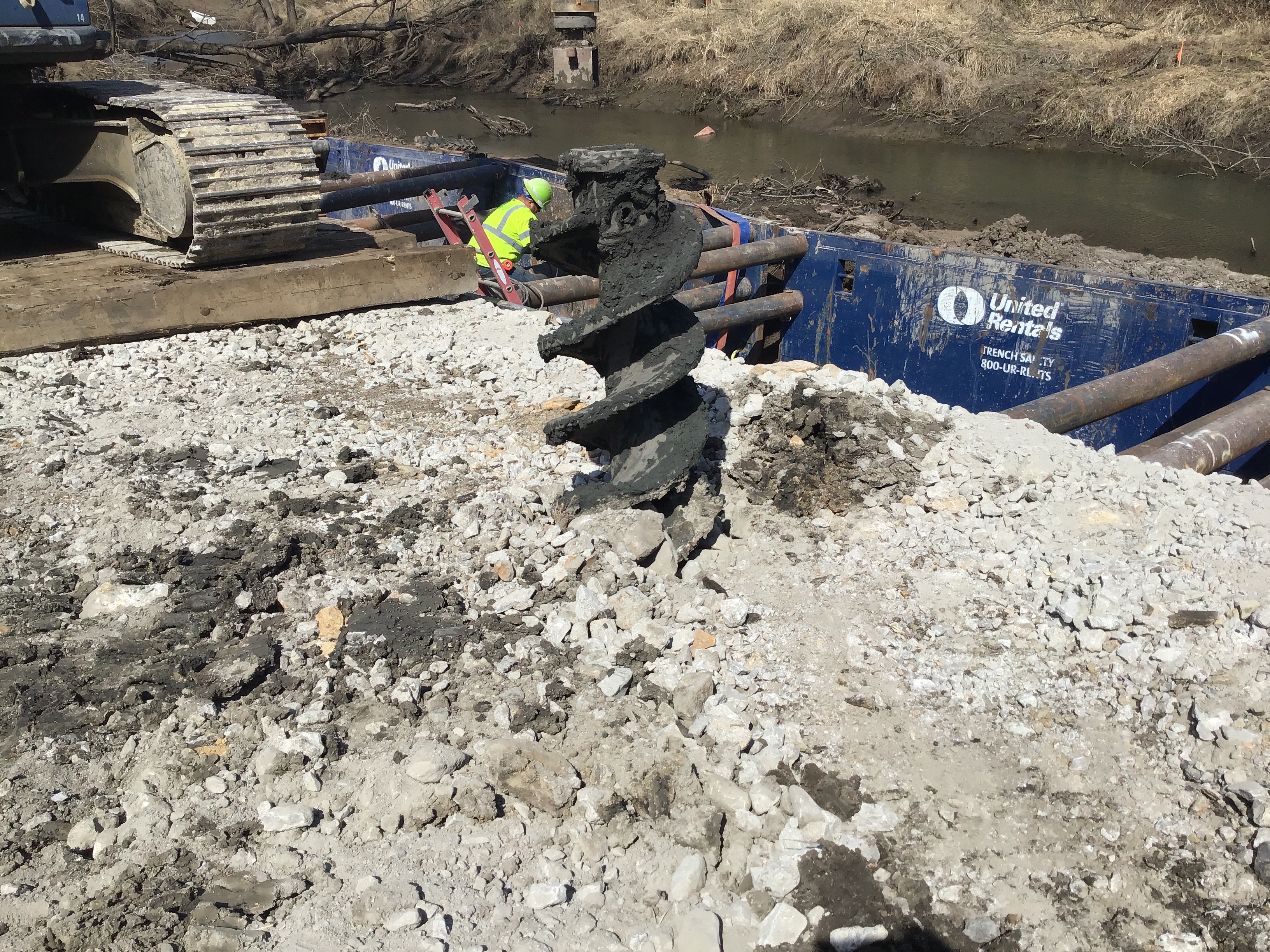

3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Water Line - Coliform Test 1 Partial 03/11/2021
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Clarkson - Gregg crew ) collected samples from Line D & A . Line A permit #PRSUBD20202246.
Miscellaneous PWORKS Inspection Partial 03/11/2021
Misc
Informational
03/10/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/10/2021
3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Misc
Informational
03/11/2021

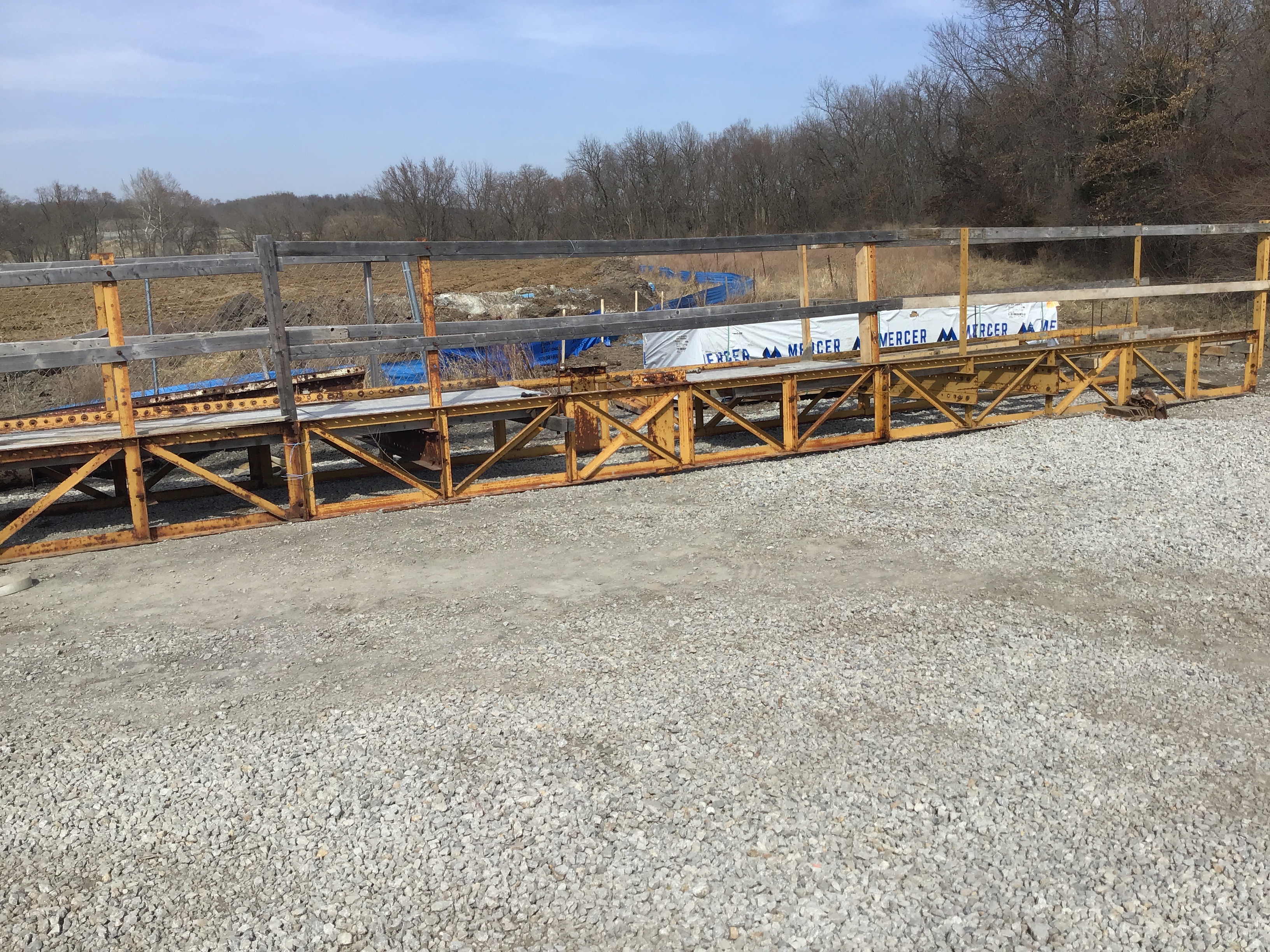

3/11/21 Thursday Contractor ( Clarkson- Bridge crew ) continue to form and construction materials for building of bridge.
Water Line - Coliform Test 2 Partial 03/12/2021
Misc
Informational
03/12/2021
3/12/21 Friday Contractor collected water samples from Line D & A.
Miscellaneous PWORKS Inspection Partial 03/16/2021
Misc
Informational
03/11/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/11/2021
3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Clarkson- Bridge crew ) continue to form and construction materials for building of bridge.
Misc
Informational
03/16/2021

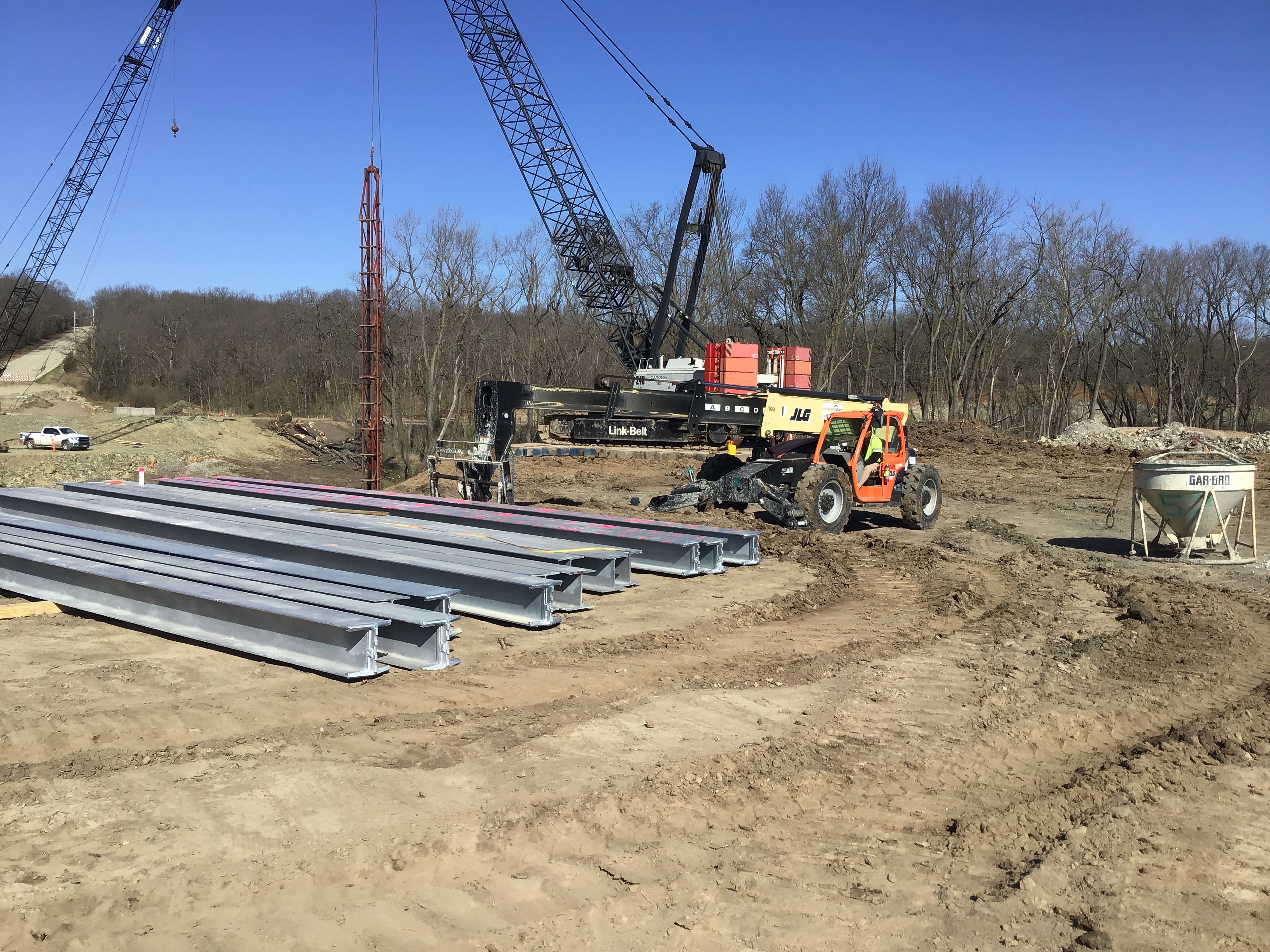

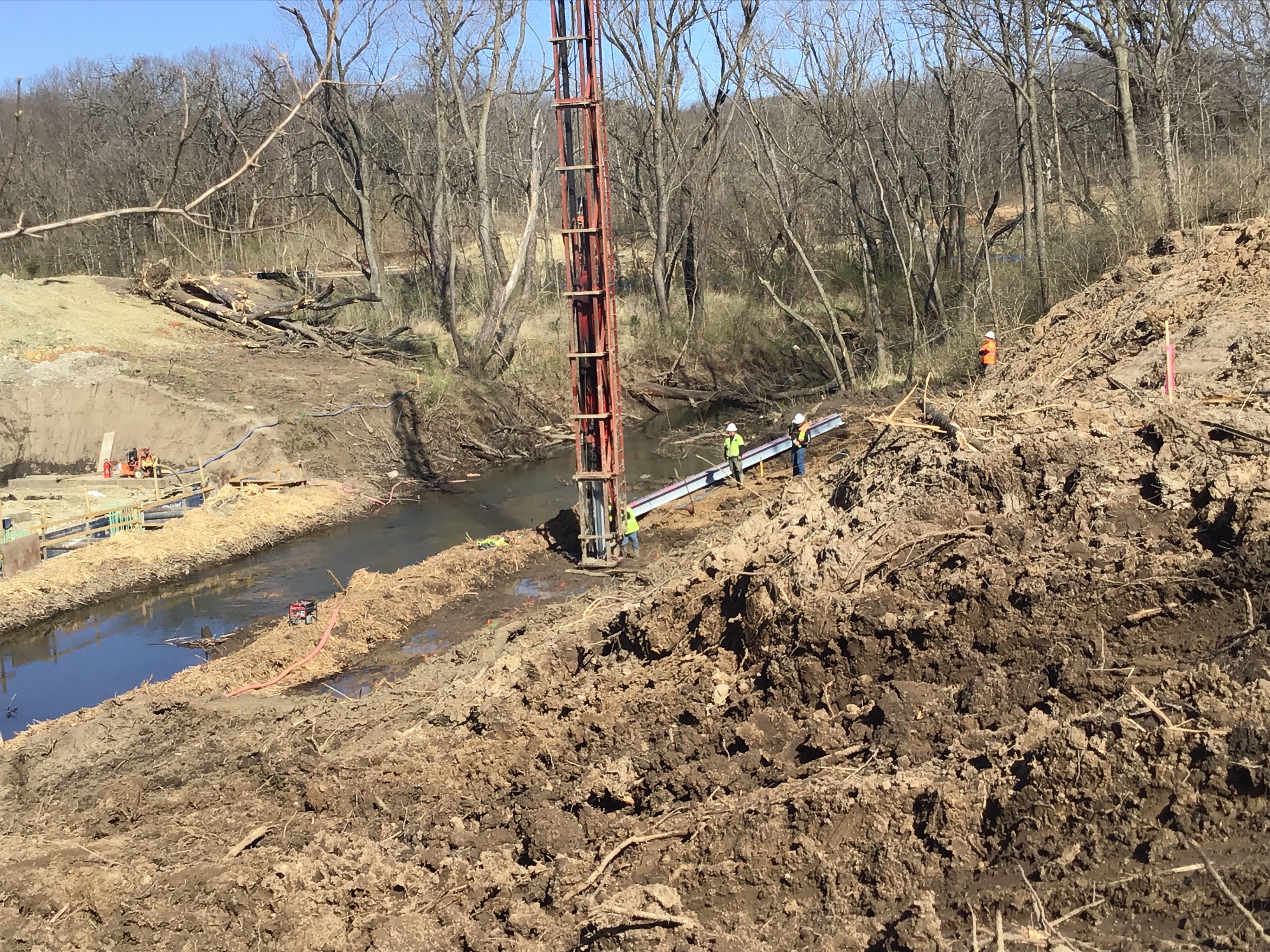

3/16/21 Tuesday Contractor ( Clarkson - Bridge crew ) began driving piles for 20ft columns. I gave my business card to Osslon to have me included on the E-mail for the reports. The contractor ran into an issue it appears that the piles maybe to short. They were not able to reach a point of resistance ( to the point of refusal ). Contractor had a longer pile delivered to site to be welded to one of the piles that was driven. Project plans calls all that the beams can be splice also Osslon will inspect weld for structural integrity. ( Bent 2)
Miscellaneous PWORKS Inspection Partial 03/22/2021
Misc
Informational
03/16/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/16/2021
3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Misc
Informational
03/16/2021
3/11/21 Thursday Contractor ( Clarkson- Bridge crew ) continue to form and construction materials for building of bridge.
Misc
Informational
03/16/2021
3/16/21 Tuesday Contractor ( Clarkson - Bridge crew ) began driving piles for 20ft columns. I gave my business card to Osslon to have me included on the E-mail for the reports. The contractor ran into an issue it appears that the piles maybe to short. They were not able to reach a point of resistance ( point of refusal ). Contractor brought in some longer columns time 4:00PM.
Misc
Informational
03/22/2021
3/22/21 Monday Contractor ( Clarkson - Bridge crew ) wielding on approximately 9’ of piling on to existing pile at staging area. One pile is left to wield at the site to extend pile so it can be hammered to refusal to reach proper depth. Contractor also build forms and wired columns & bridge materials for bridge construction.
Miscellaneous PWORKS Inspection Partial 03/23/2021
Misc
Informational
03/22/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/22/2021
3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Misc
Informational
03/22/2021
3/11/21 Thursday Contractor ( Clarkson- Bridge crew ) continue to form and construction materials for building of bridge.
Misc
Informational
03/22/2021
3/16/21 Tuesday Contractor ( Clarkson - Bridge crew ) began driving piles for 20ft columns. I gave my business card to Osslon to have me included on the E-mail for the reports. The contractor ran into an issue it appears that the piles maybe to short. They were not able to reach a point of resistance ( point of refusal ). Contractor brought in some longer columns time 4:00PM.
Misc
Informational
03/22/2021
3/22/21 Monday Contractor ( Clarkson - Bridge crew ) wielding on approximately 9’ of piling on to existing pile at staging area. One pile is left to wield at the site to extend pile so it can be hammered to refusal to reach proper depth. Contractor also build forms and wired columns & bridge materials for bridge construction.
Misc
Informational
03/23/2021
3/23/21 Tuesday Overcast and lite to medium raining throughout the day. Contractor ( Clarkson - Bridge crew ) continued to wield piles to the correct length & build forms at staging location.
Miscellaneous PWORKS Inspection Partial 03/26/2021
Misc
Informational
03/23/2021
3/9/21 Tuesday Contractor has been underway to construct Bridge over waterway as per plan. Construction started at Bent NO. 2 . Today water had to be pump out of construction site due to the upstream dam being worked on by the Core of Engineers at Lake Lackawanna ( water was allowed down stream so they could repair pipes). Going forward they will inform the contractor ( Clarkston ) when they intend allow water to flow down stream. A Temporary containment cylinder was installed. Sand is being poured into the temporary containment cylinder that sit in the Footing that were installed last week to the depth in which piles are be driven into the ground (to the shell rock).
Misc
Informational
03/23/2021
3/10/21 Wednesday the contractor finished the drilling in the forms and filled the temporary casting column with sand after removing existing soil. Bridge move to preparing Eastside of waterway for Bent #3 clearing branches and excavating soil. Project day for Pile to be hammer in Bent #2 is 3/15/21.
Misc
Informational
03/23/2021
3/11/21 Thursday Contractor ( Clarkson- Bridge crew ) continue to form and construction materials for building of bridge.
Misc
Informational
03/23/2021
3/16/21 Tuesday Contractor ( Clarkson - Bridge crew ) began driving piles for 20ft columns. I gave my business card to Osslon to have me included on the E-mail for the reports. The contractor ran into an issue it appears that the piles maybe to short. They were not able to reach a point of resistance ( point of refusal ). Contractor brought in some longer columns time 4:00PM.
Misc
Informational
03/23/2021
3/22/21 Monday Contractor ( Clarkson - Bridge crew ) wielding on approximately 9’ of piling on to existing pile at staging area. One pile is left to wield at the site to extend pile so it can be hammered to refusal to reach proper depth. Contractor also build forms and wired columns & bridge materials for bridge construction.
Misc
Informational
03/23/2021
3/23/21 Tuesday Overcast and lite to medium raining throughout the day. Contractor ( Clarkson - Bridge crew ) continued to wield piles to the correct length & build forms at staging location.
Miscellaneous Correction
Informational
03/26/2021

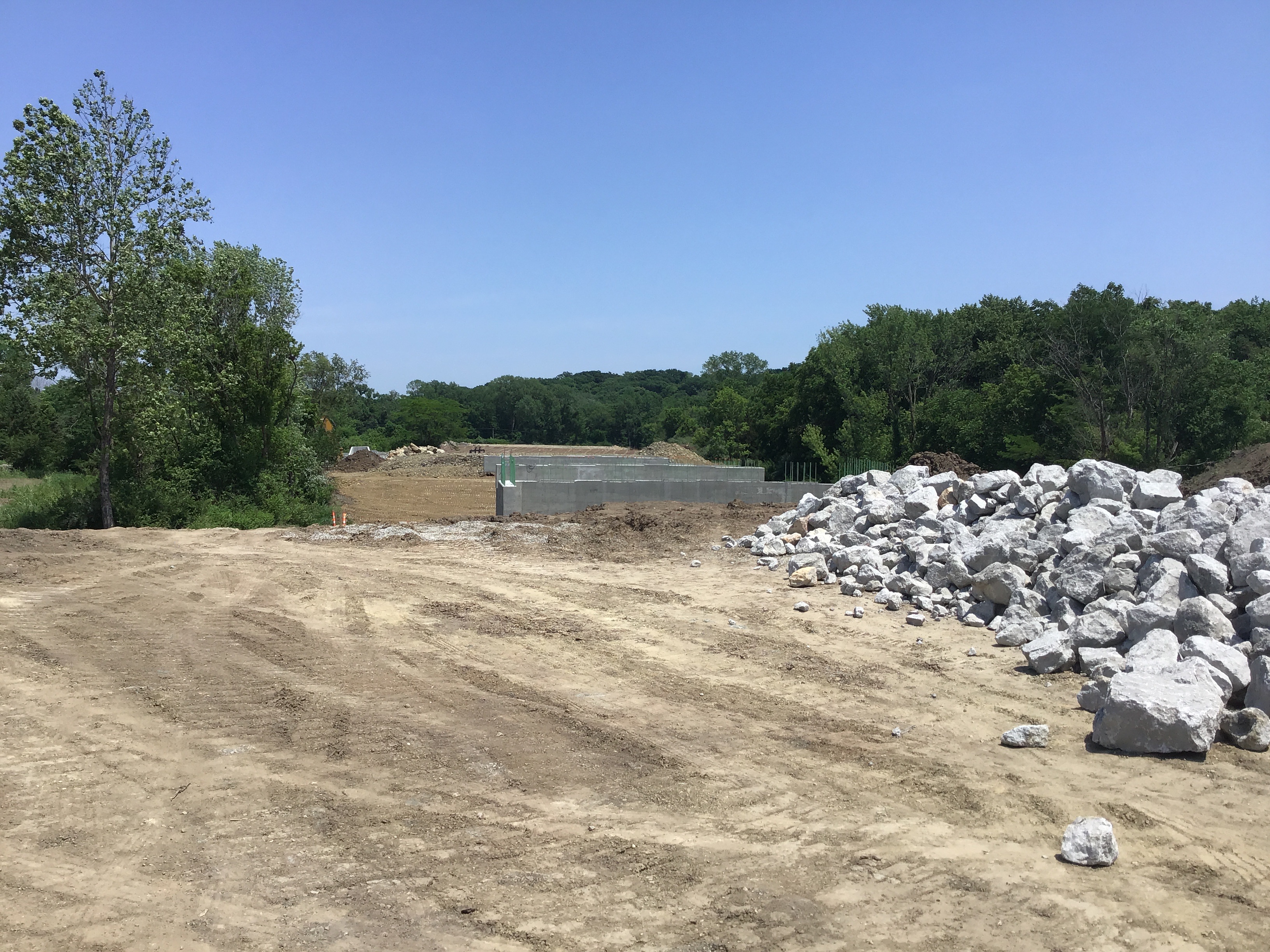

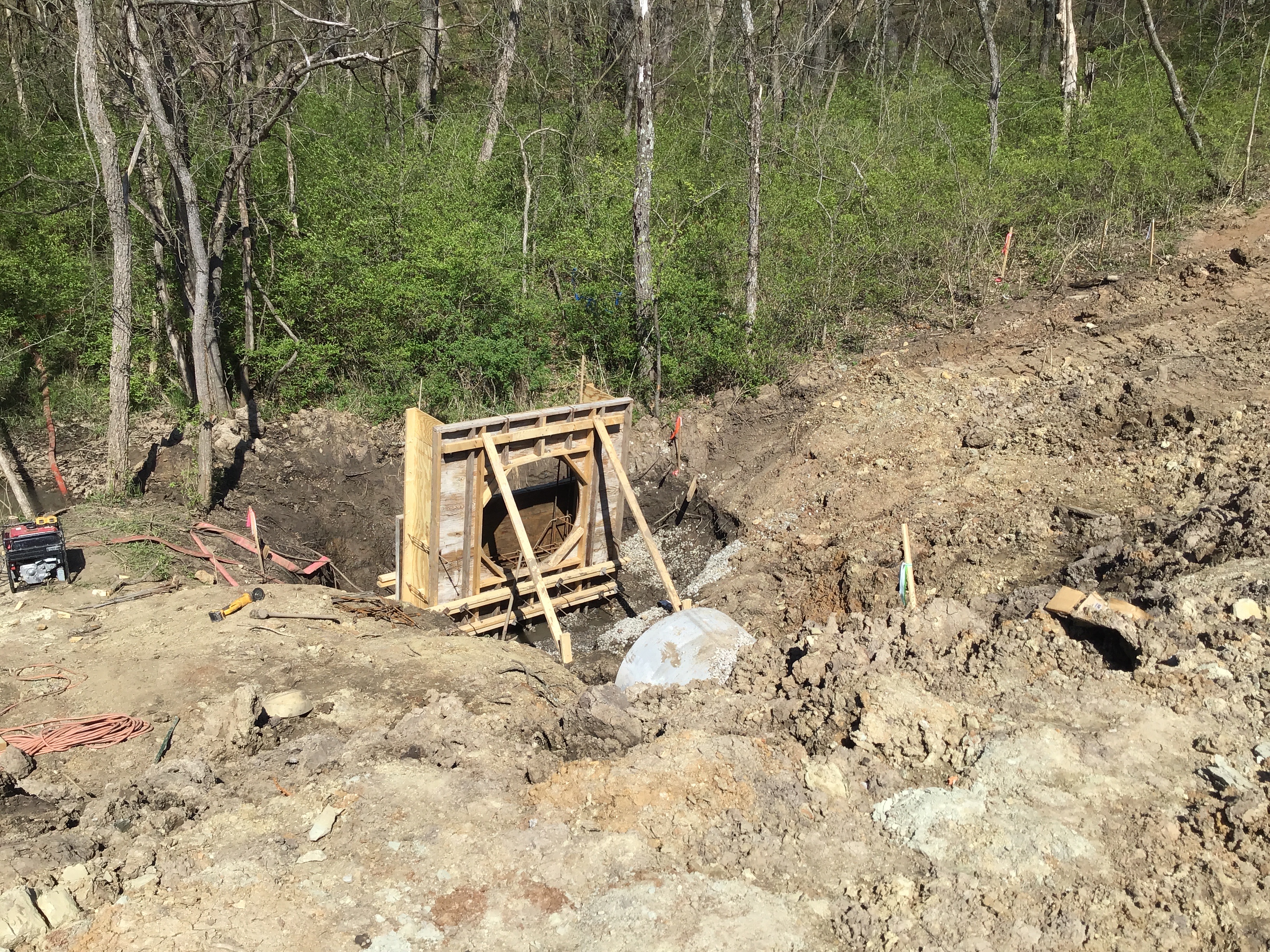

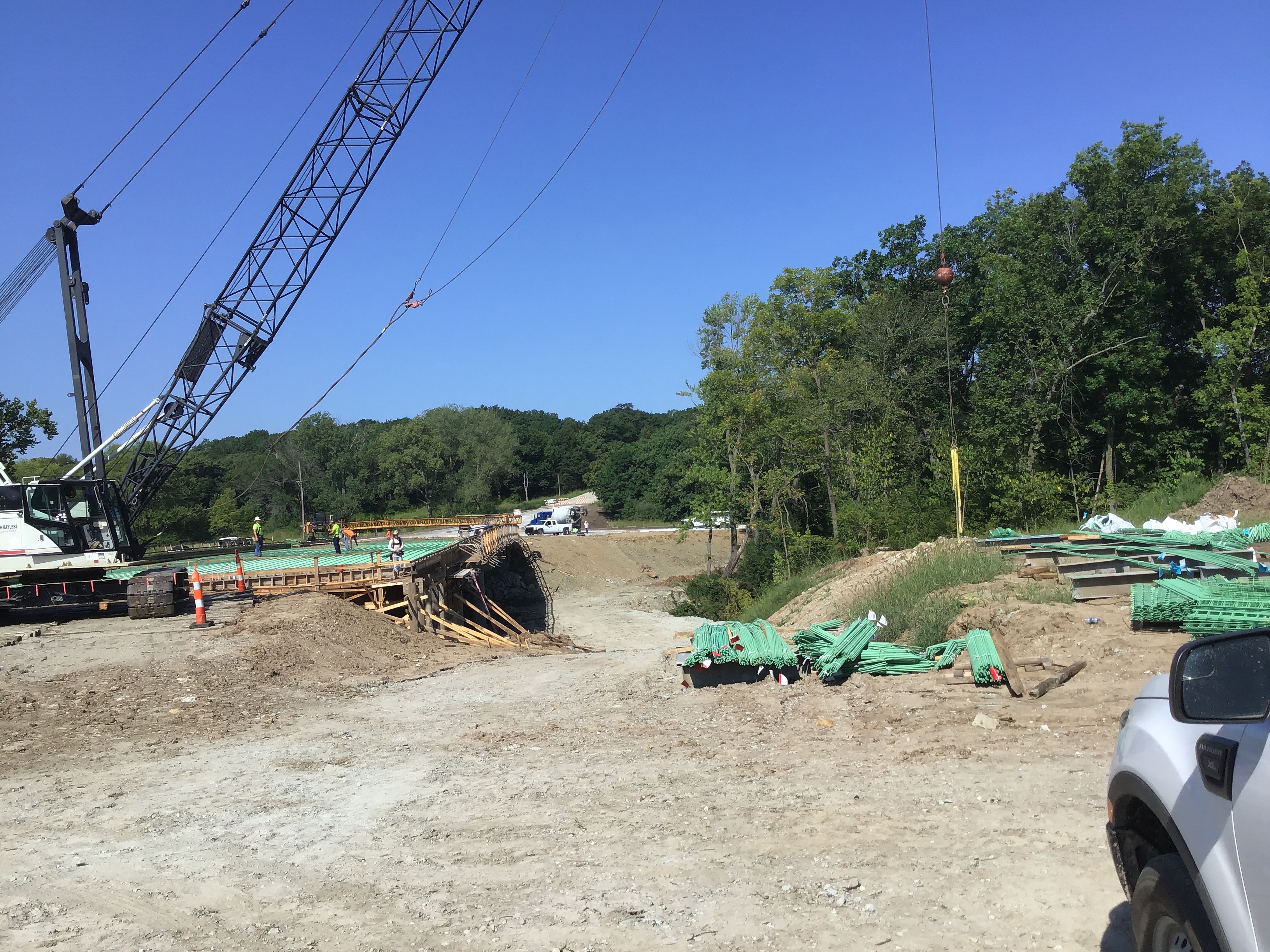

Installing the bases for the bridge. Olsen was doing 3rd party inspections.
Miscellaneous PWORKS Inspection Partial 03/30/2021
Misc
Informational
03/30/2021

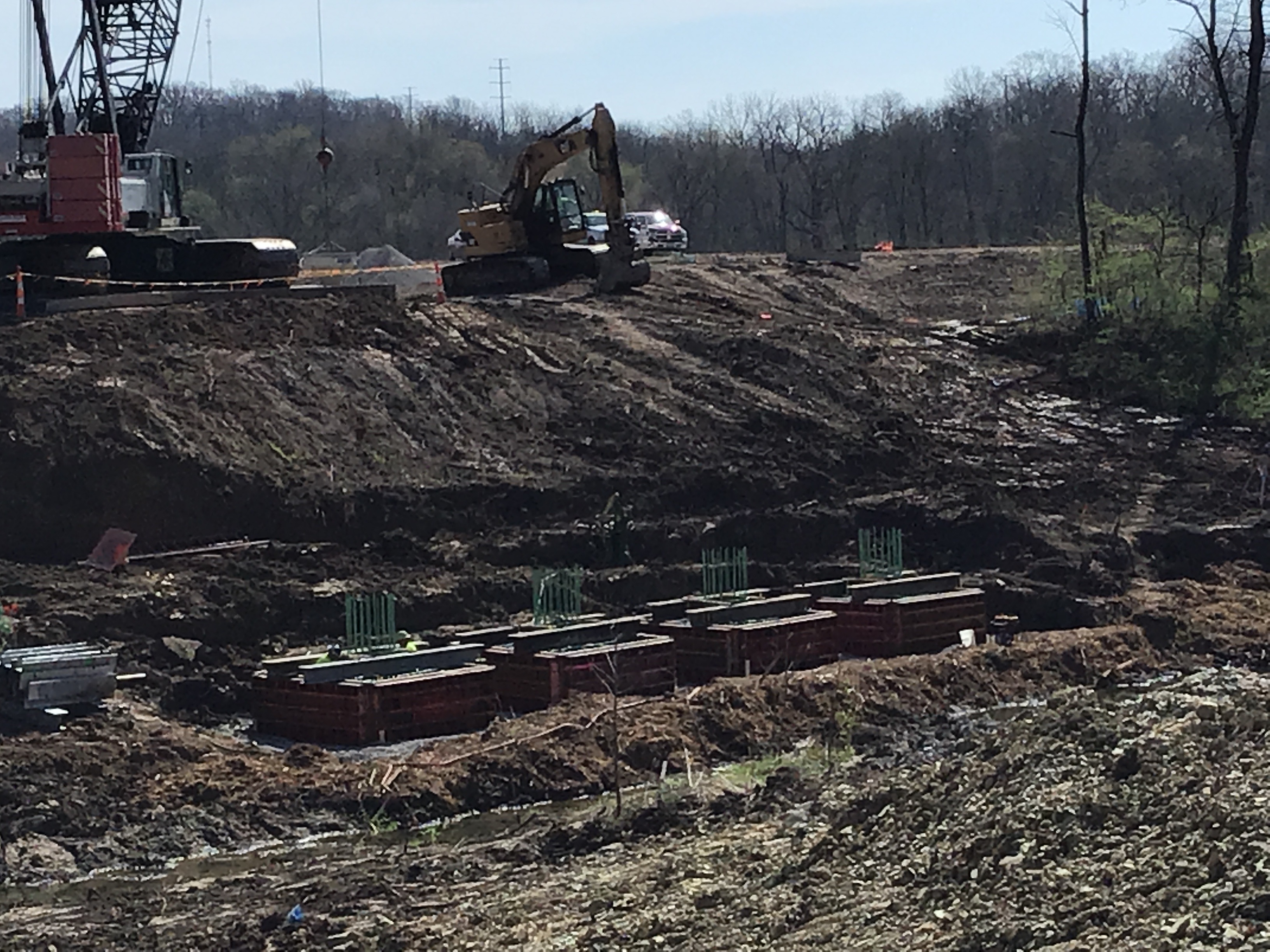

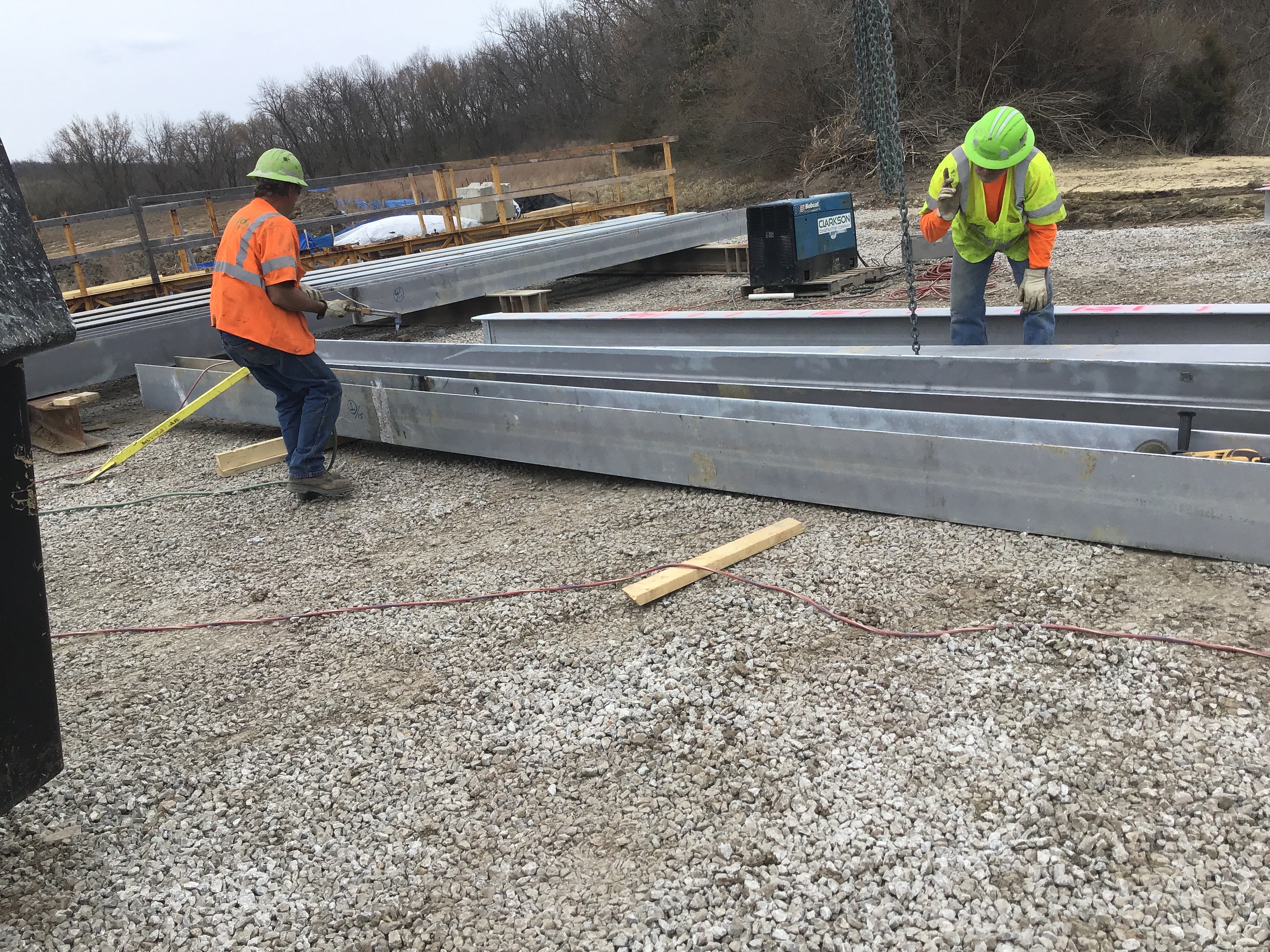

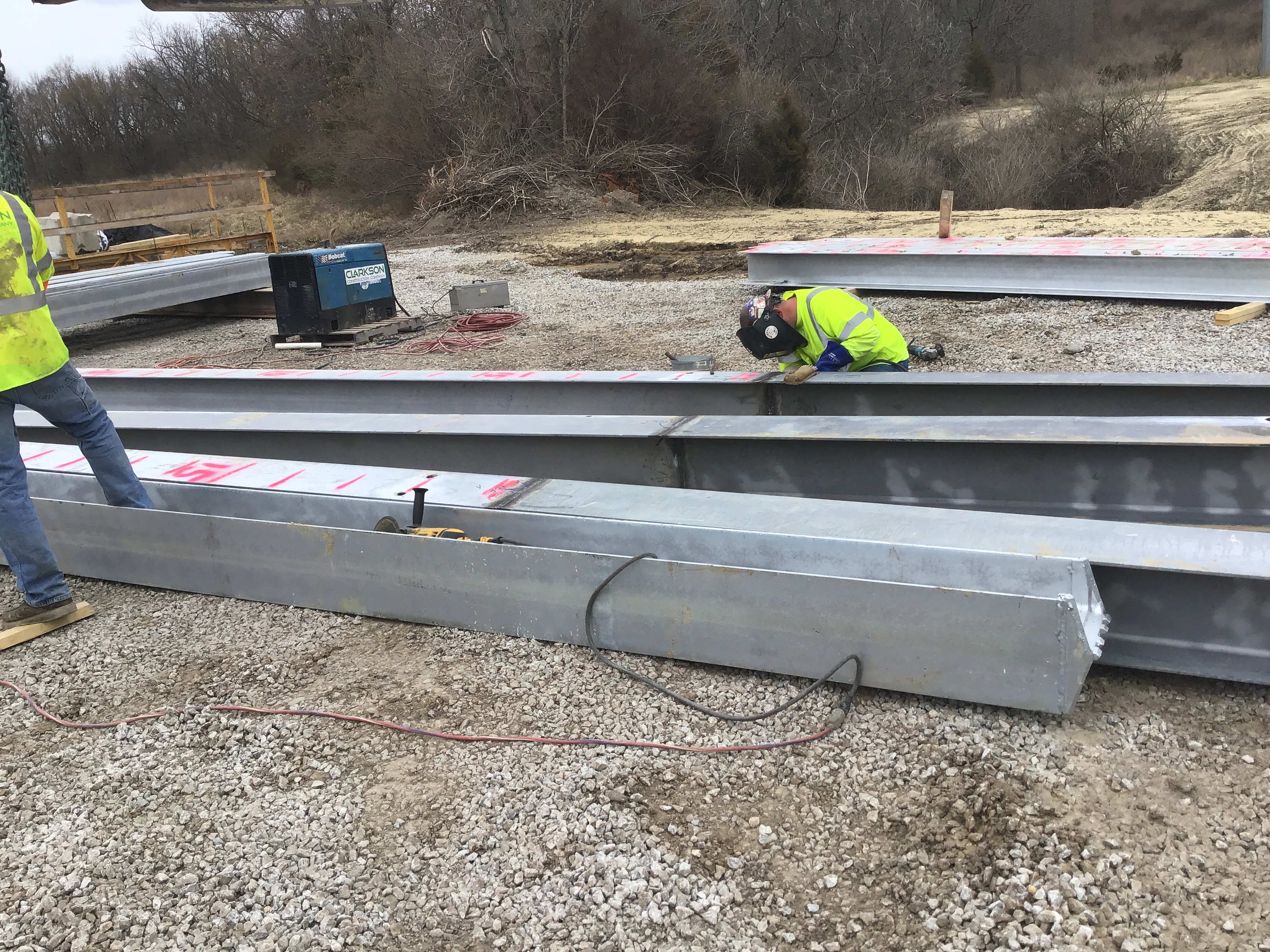

3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Water Line - Construction Inspection Partial 03/31/2021
Misc
Informational
03/09/2021
10/28/20 Wednesday Contractor has installed over 400’ of water main on Line D this was reported on PRSITE 20202246 . The Line D is connected with Line A it Tee of @ the Northside entrance of project off of View High Drive. Hydrant was installed @ Sta 03+97.31 and contractor continued to install water Line D.
Misc
Informational
03/09/2021
Misc
Informational
03/09/2021
3/9/21 Tuesday Contractor Chlorinated Line A & D to 03+70 @ 2:00PM. Contractor also corrected a leak that occurred to Line A around the air relief valve ( possibly leak due to the heavy truck and equipment coming through entrance area ). All were swab with chlorine and flushed.
Misc
Informational
03/31/2021

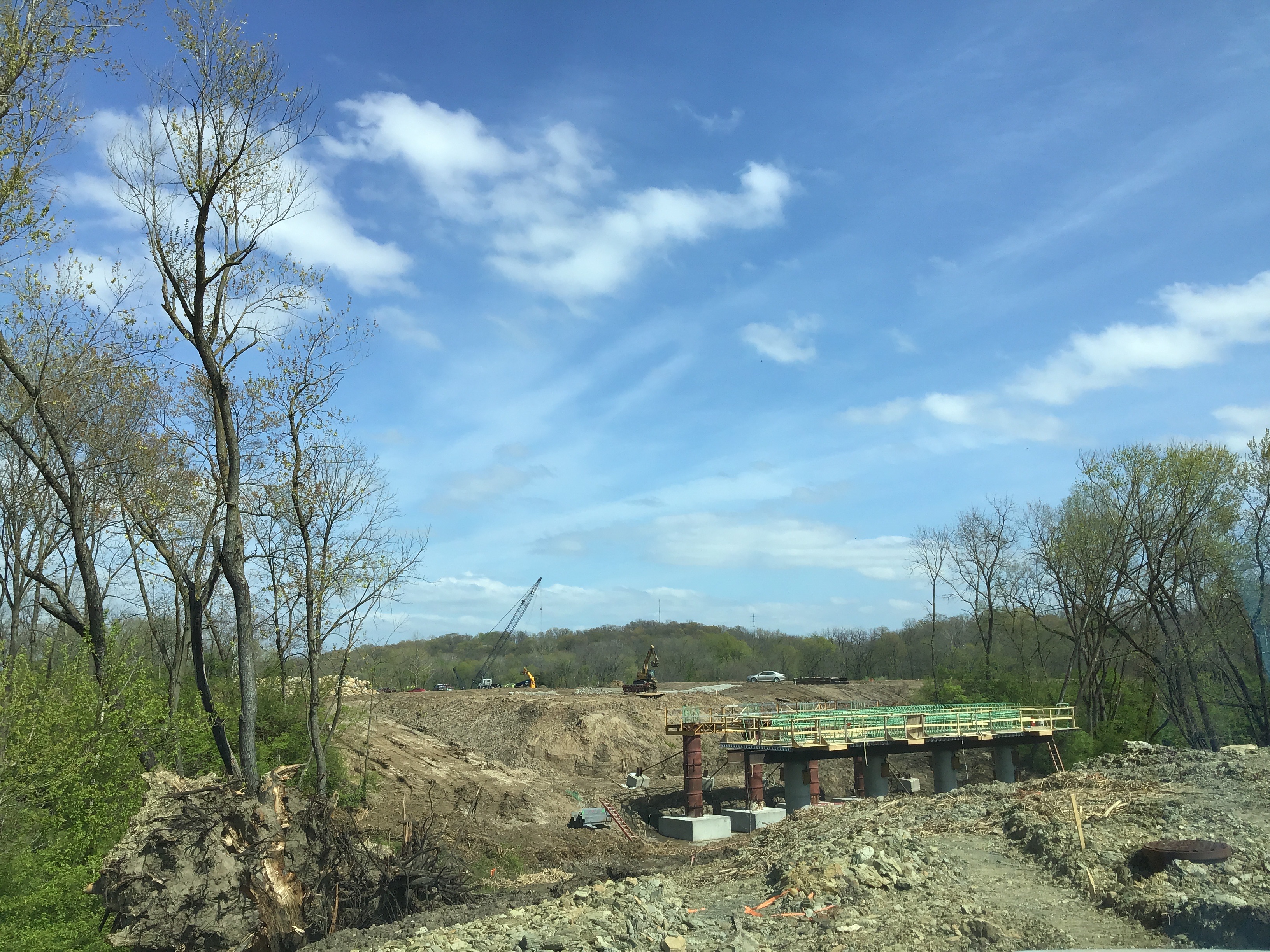

3/31/21 Wednesday Contractor ( Clarkson Gregg - crew ) has started working in the Lee’s boundary on water Line B. I will establish the approximate Station in future reports. 8” DIP water main is being installed as-per plan. The line connect to the Lee Summit side of the water main at View High Dr. and runs on the Northside of the road of View High Pkwy. Approximately 800 ft was is in the City of Kansas City Boundries.
Miscellaneous PWORKS Inspection Partial 03/31/2021
Misc
Informational
03/30/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
03/31/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Miscellaneous PWORKS Inspection Partial 04/01/2021
Misc
Informational
03/31/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
03/31/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/01/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Miscellaneous PWORKS Inspection Partial 04/01/2021
Misc
Informational
04/01/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/01/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/01/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/01/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Miscellaneous PWORKS Inspection Partial 04/02/2021
Misc
Informational
04/01/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/01/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/01/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/01/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/02/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Miscellaneous PWORKS Inspection Partial 04/05/2021
Misc
Informational
04/02/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/02/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/02/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/02/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/02/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/05/2021

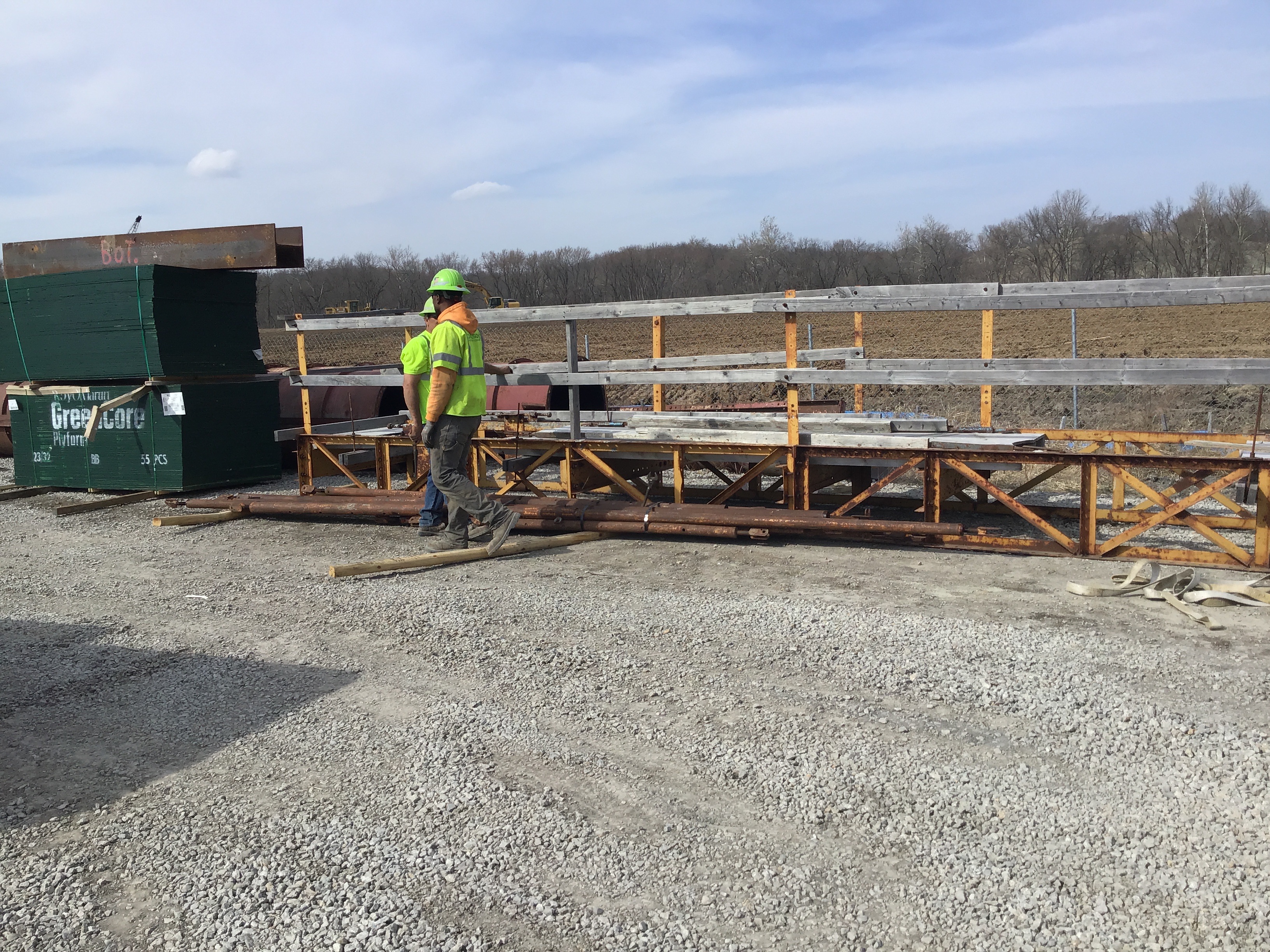

4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/05/2021

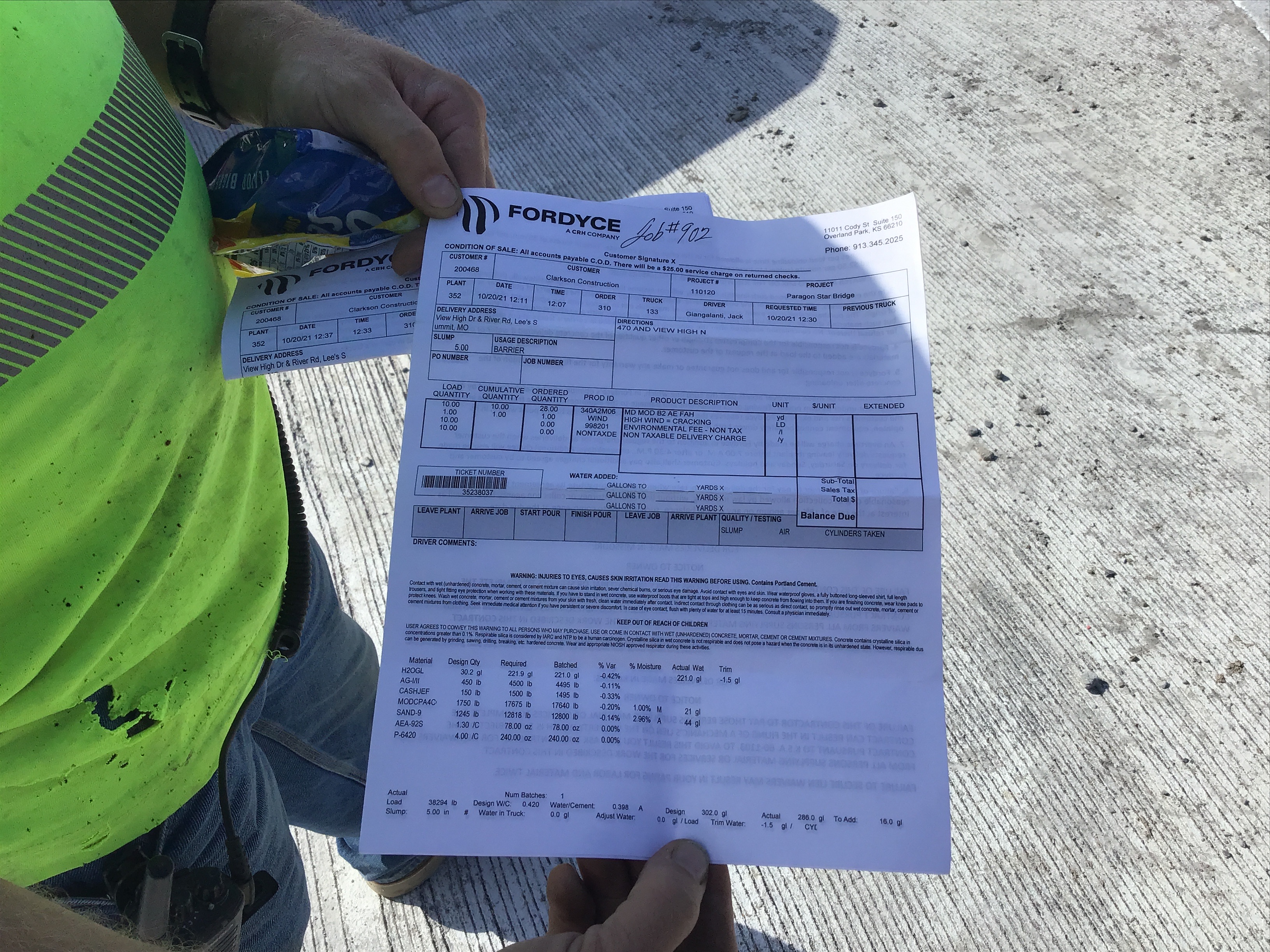

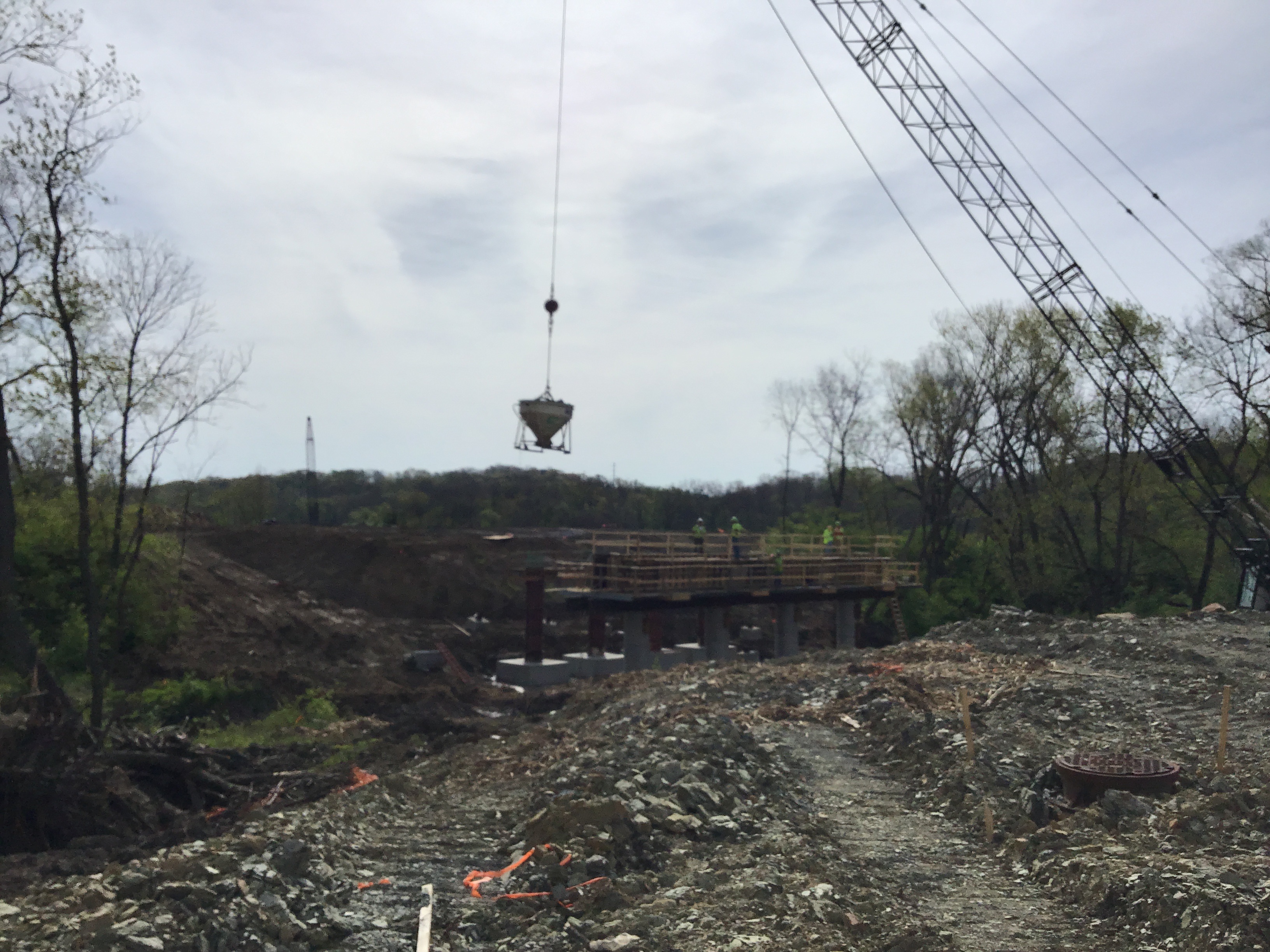

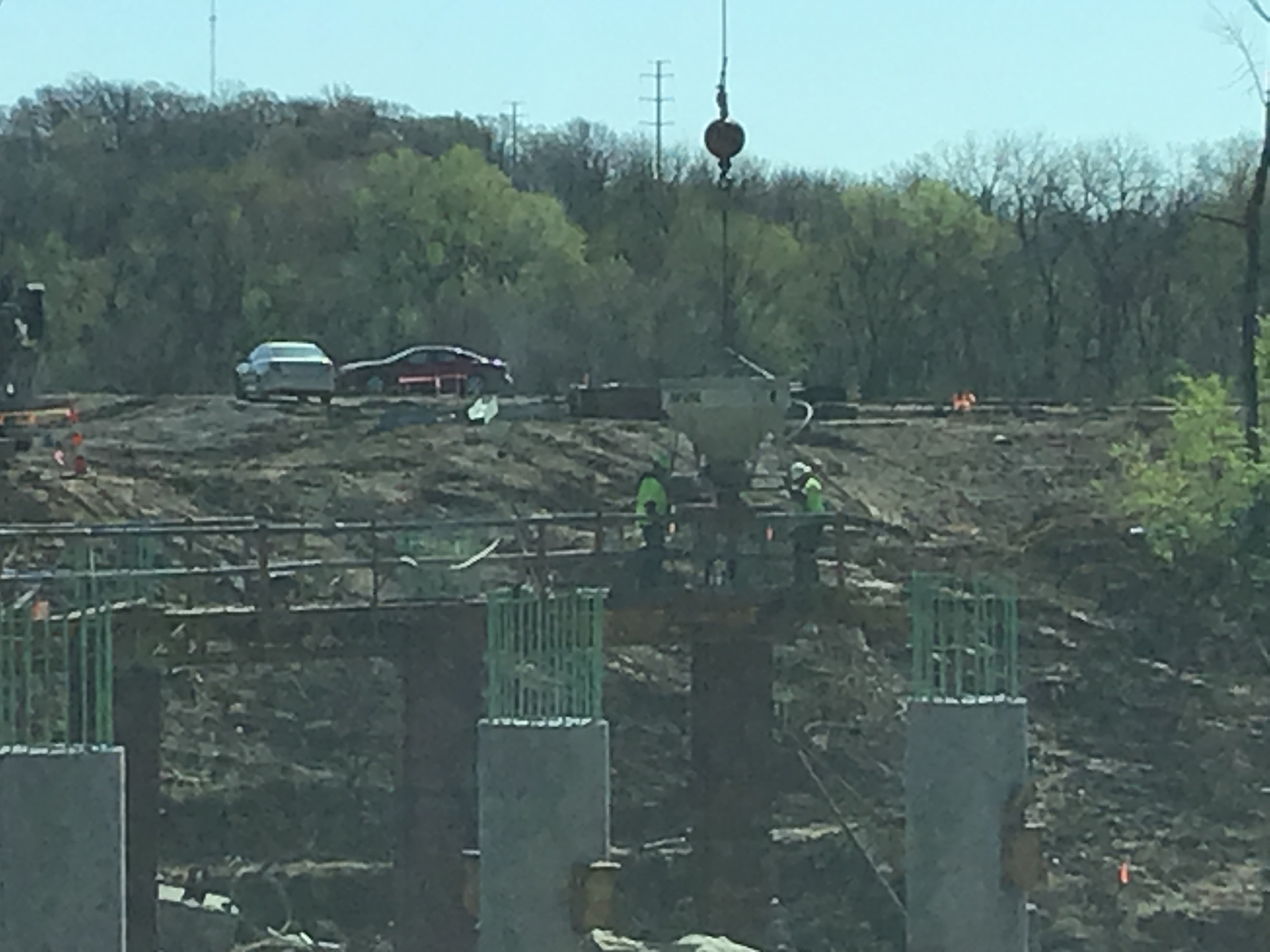

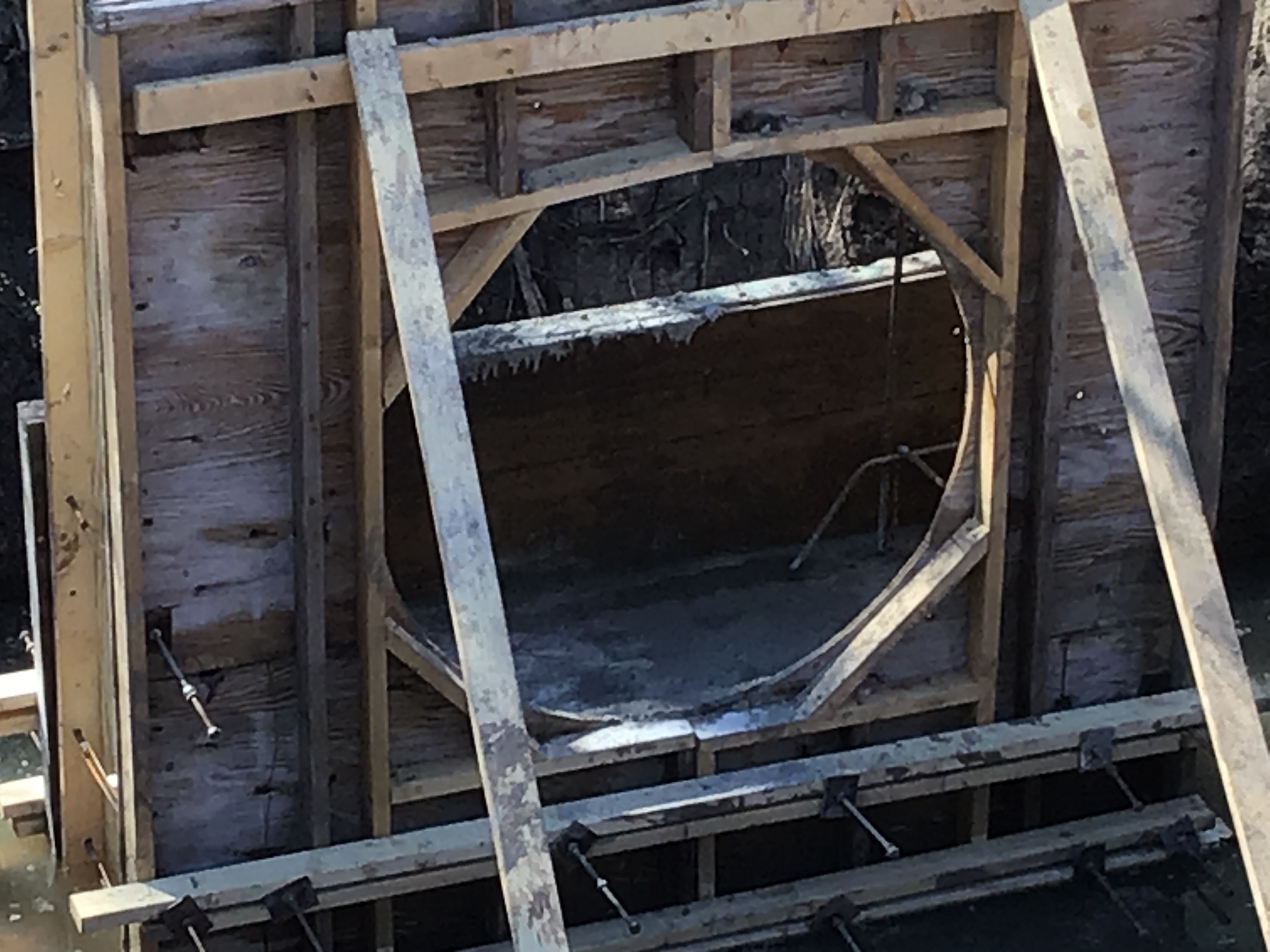

4/5/21 Monday Contractor (Clarkson - Bridge crew) began to pour concrete for base footing on Bent 3 and framed continued rebar framing columns for Bent 2 Westside of waterway.
Miscellaneous PWORKS Inspection Partial 04/06/2021
Misc
Informational
04/05/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/05/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/05/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/05/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/05/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/05/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/06/2021

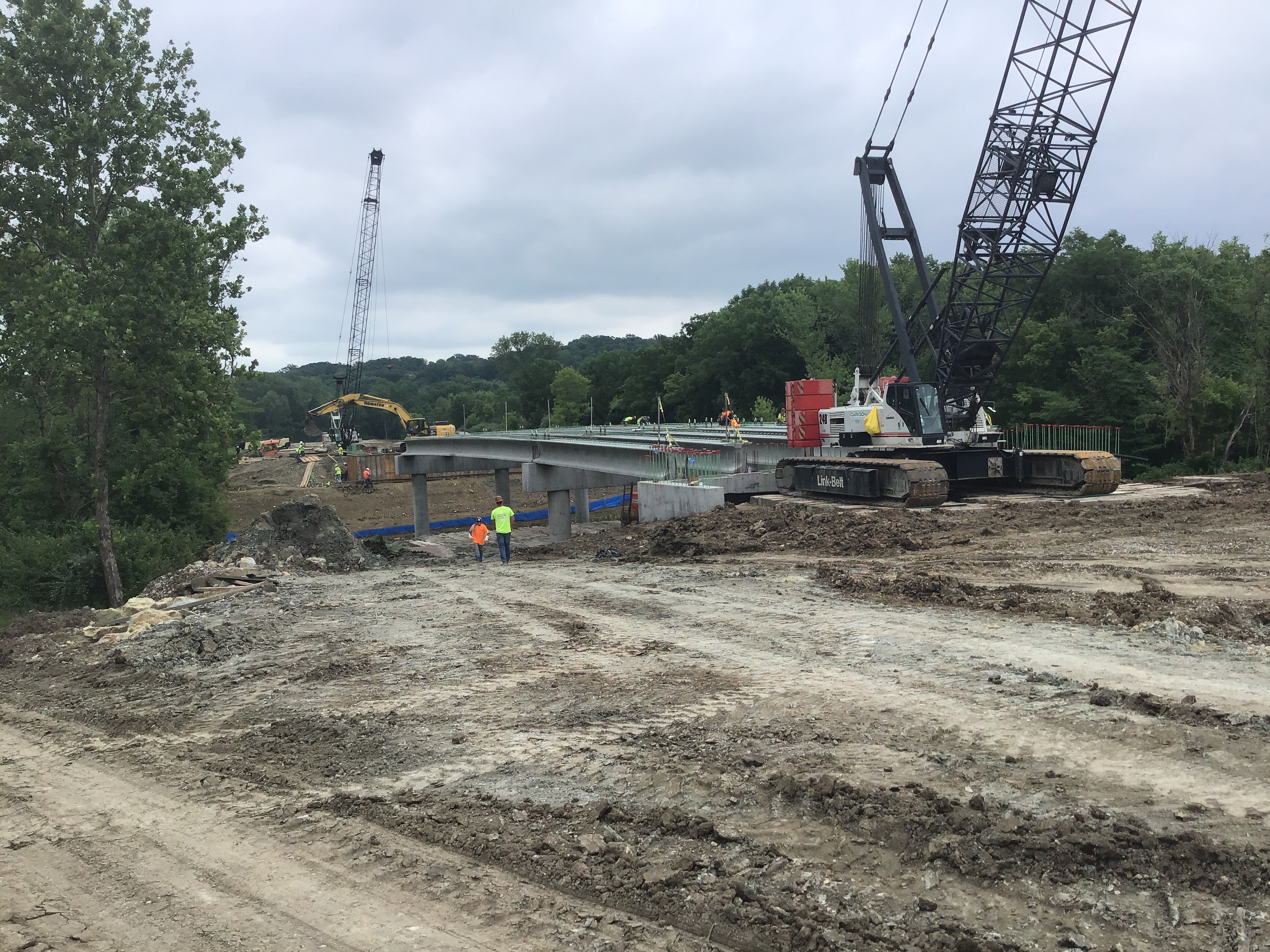

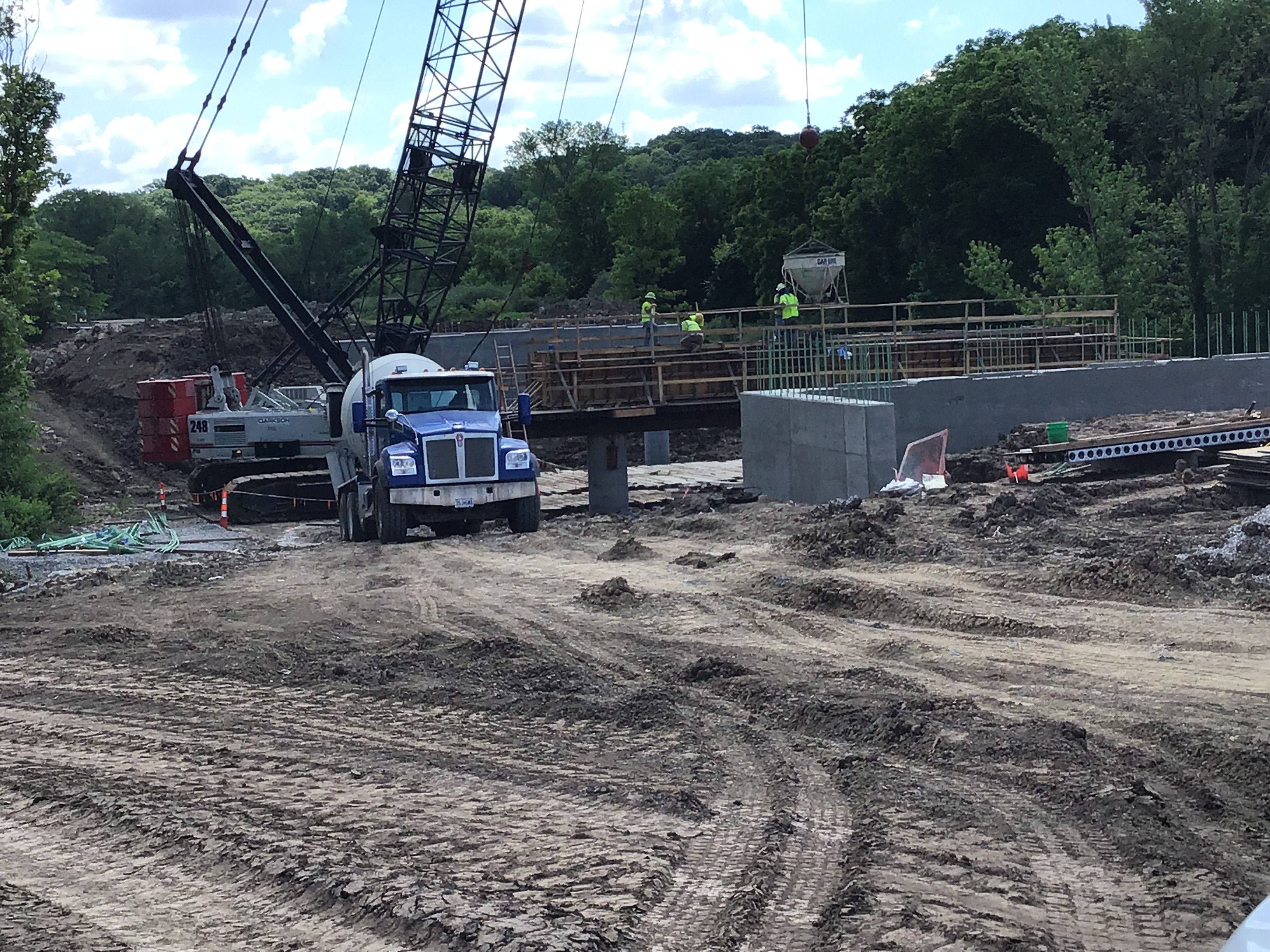

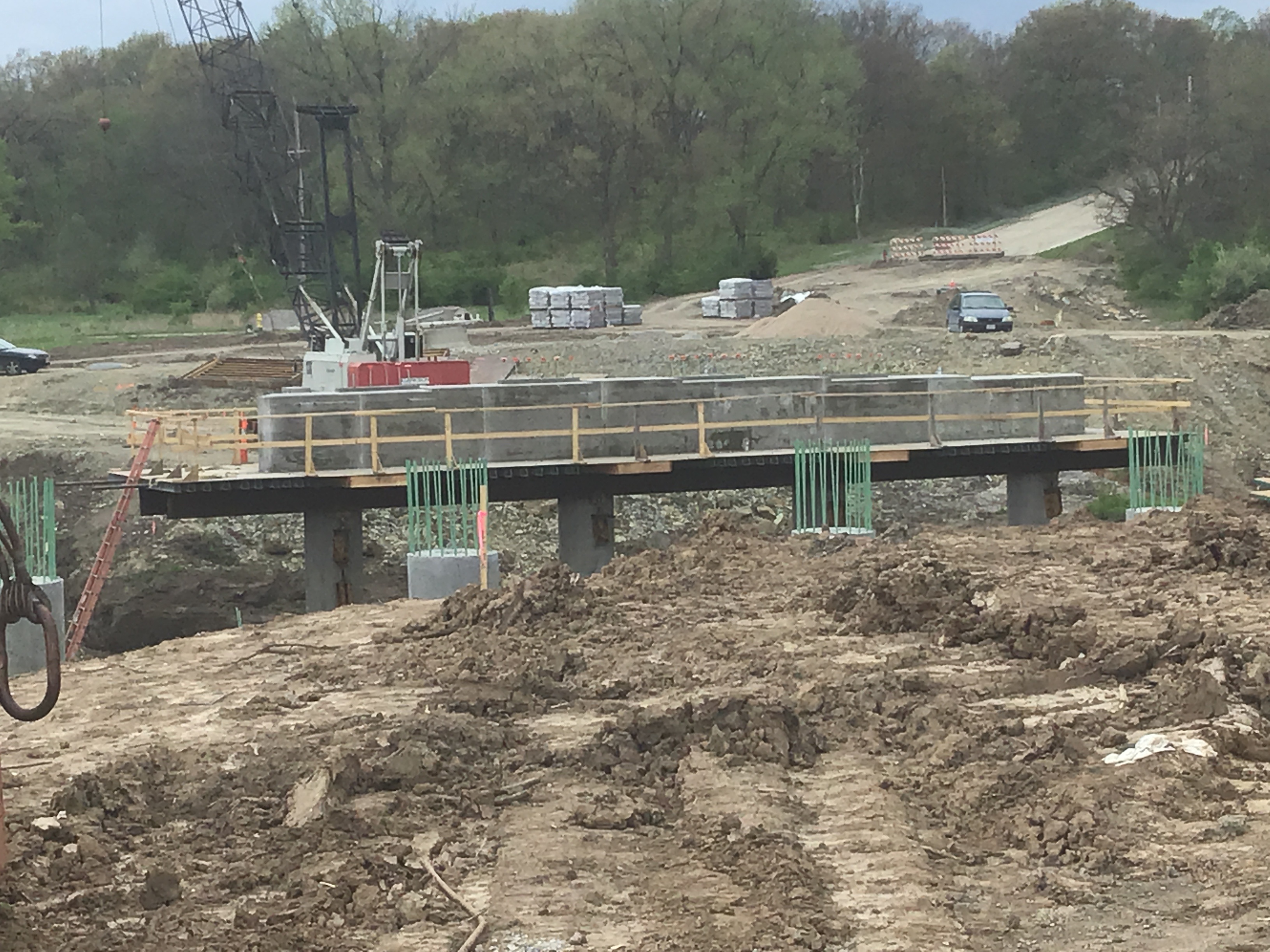

4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Miscellaneous PWORKS Inspection Partial 04/12/2021
Misc
Informational
04/06/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/06/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/06/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/06/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/06/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/06/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/06/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/12/2021

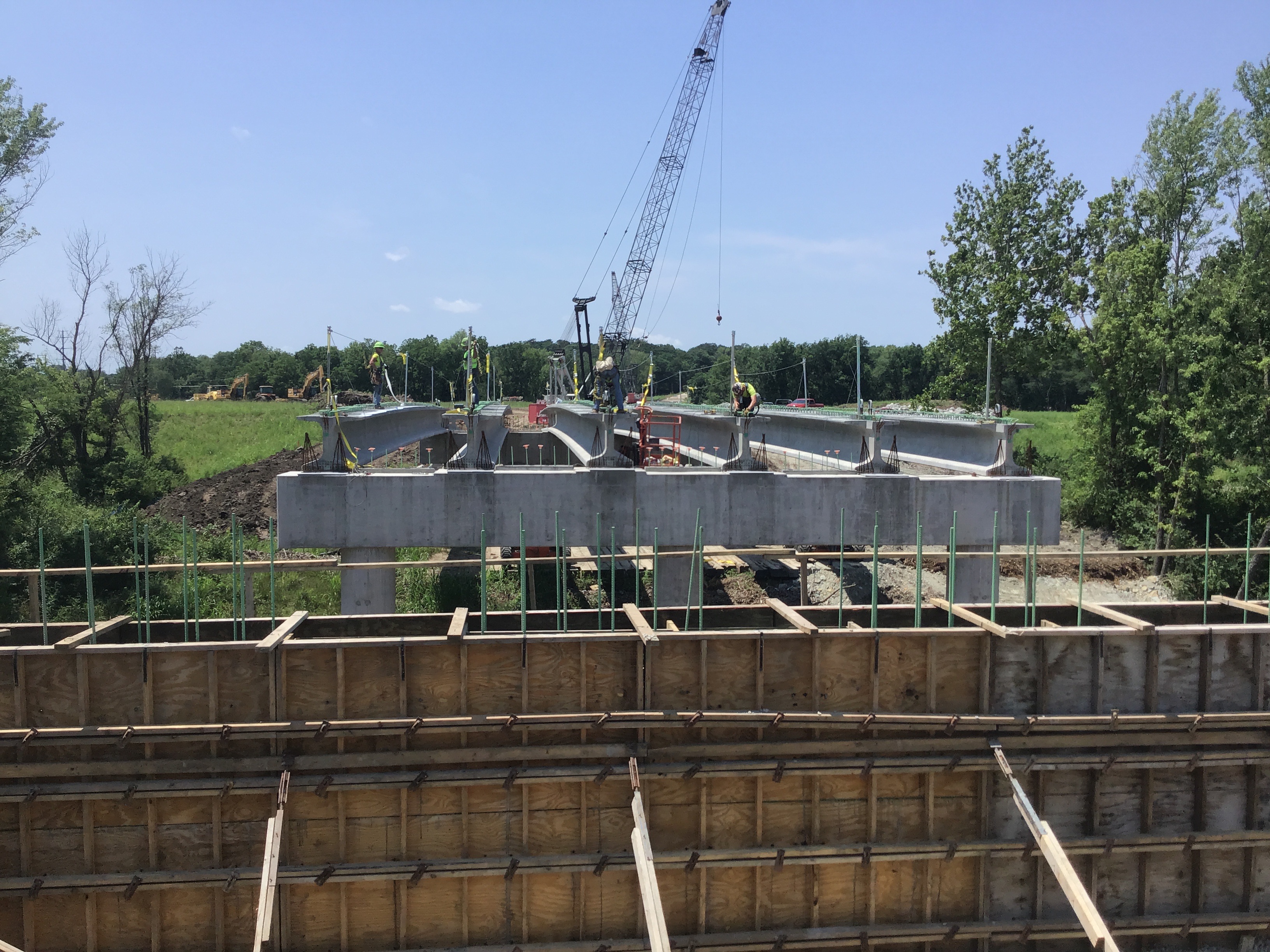

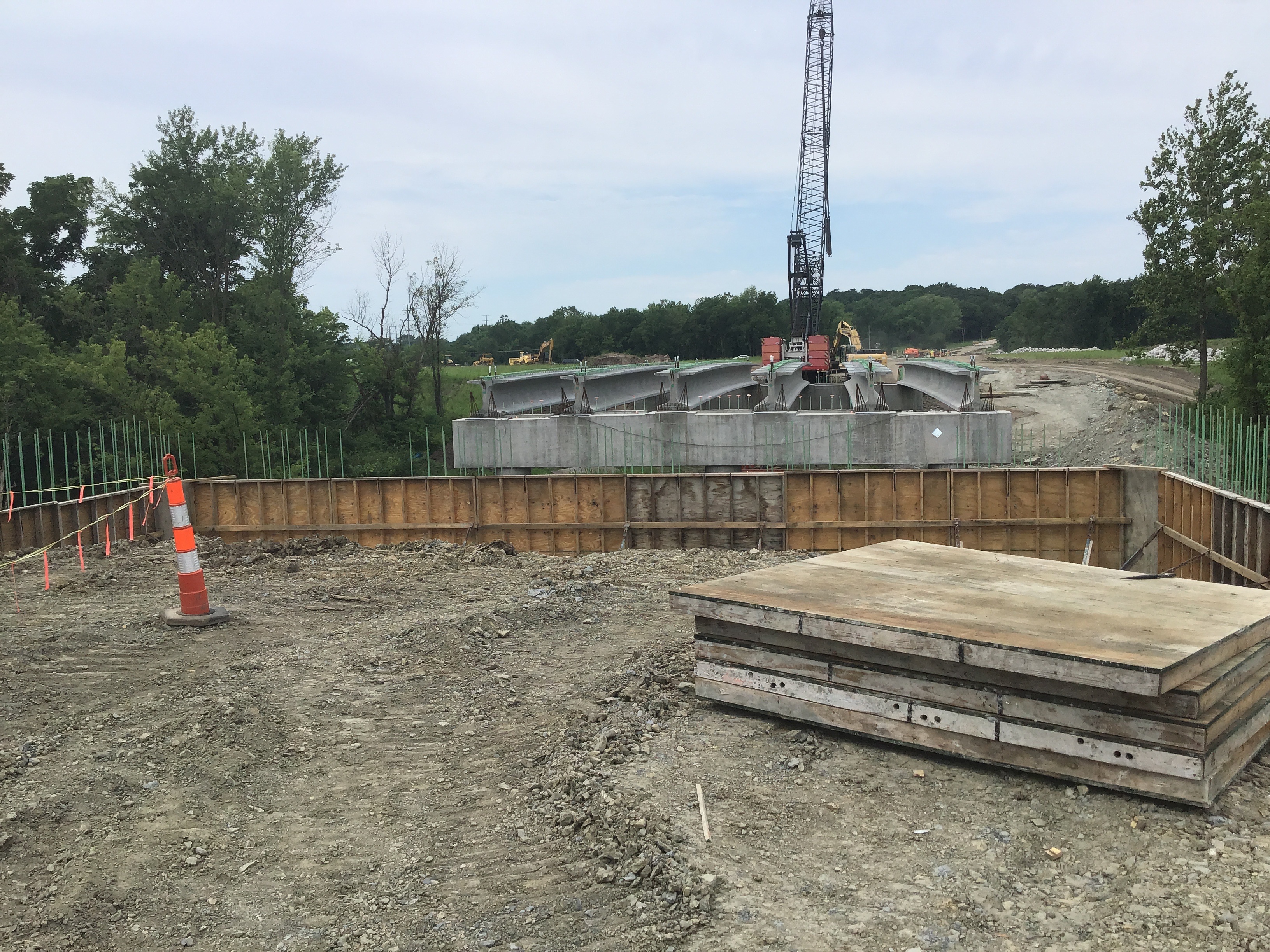

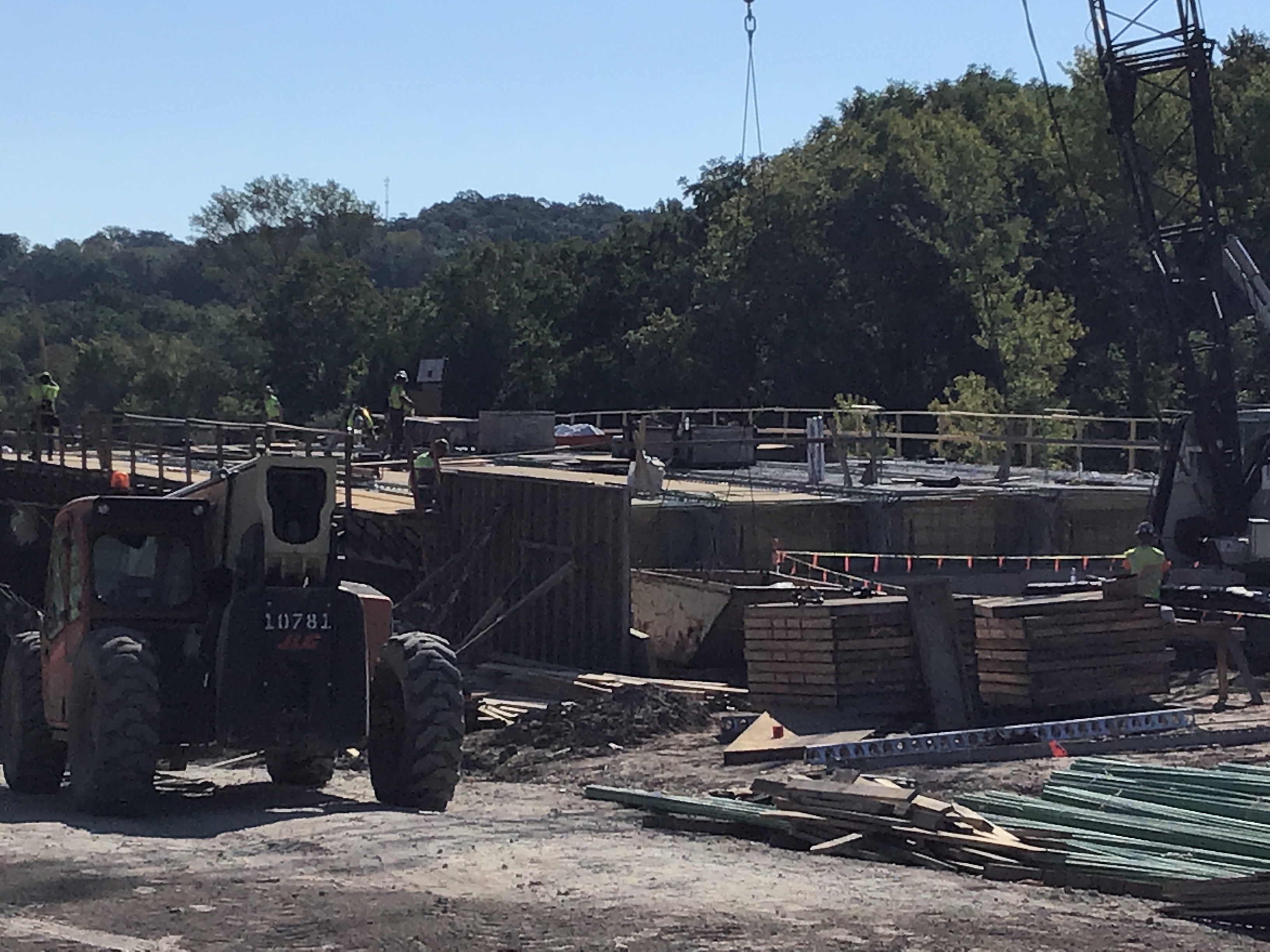

4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Miscellaneous PWORKS Inspection Partial 04/13/2021
Misc
Informational
04/12/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/12/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/12/2021

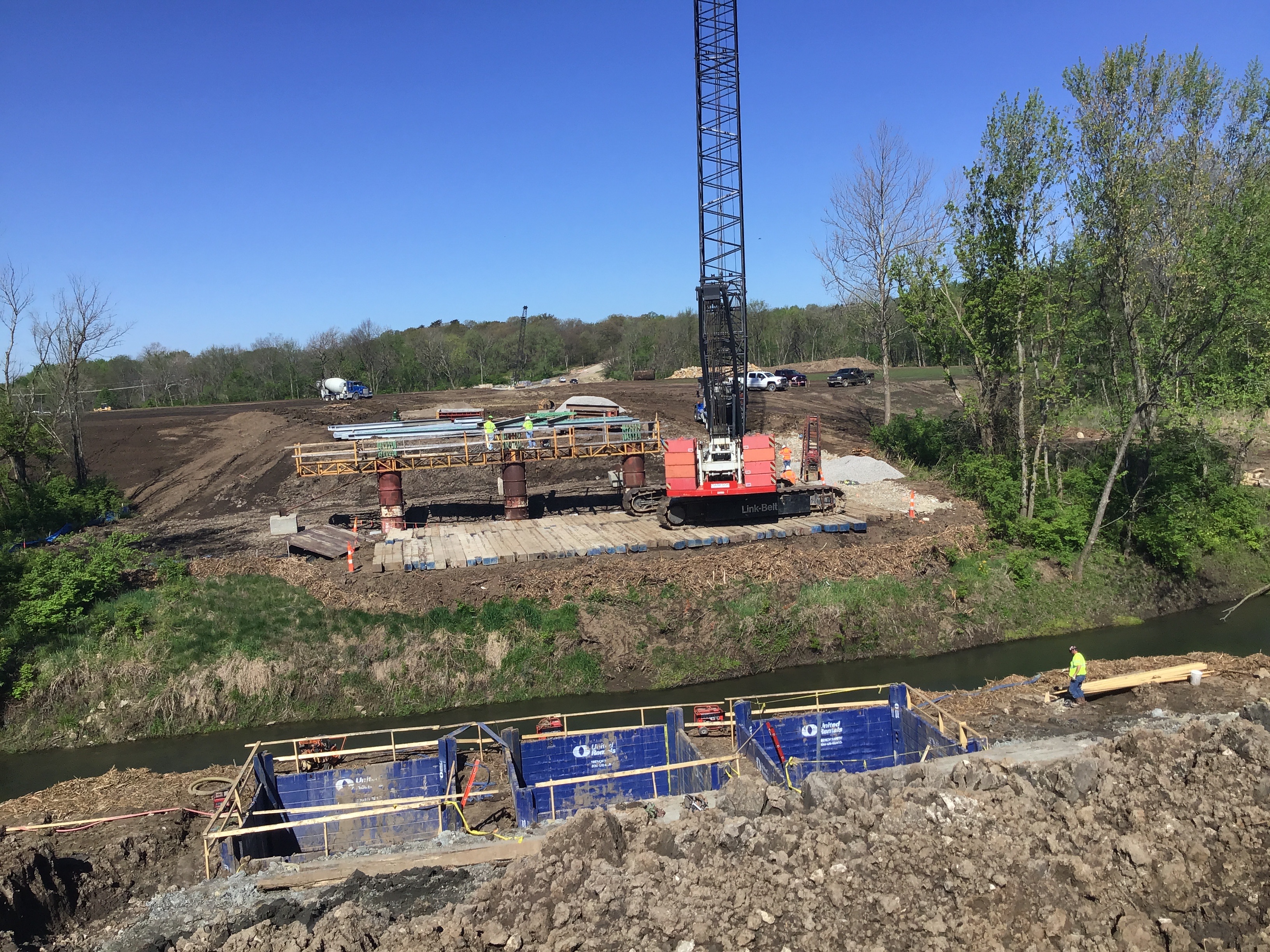

4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/12/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/12/2021

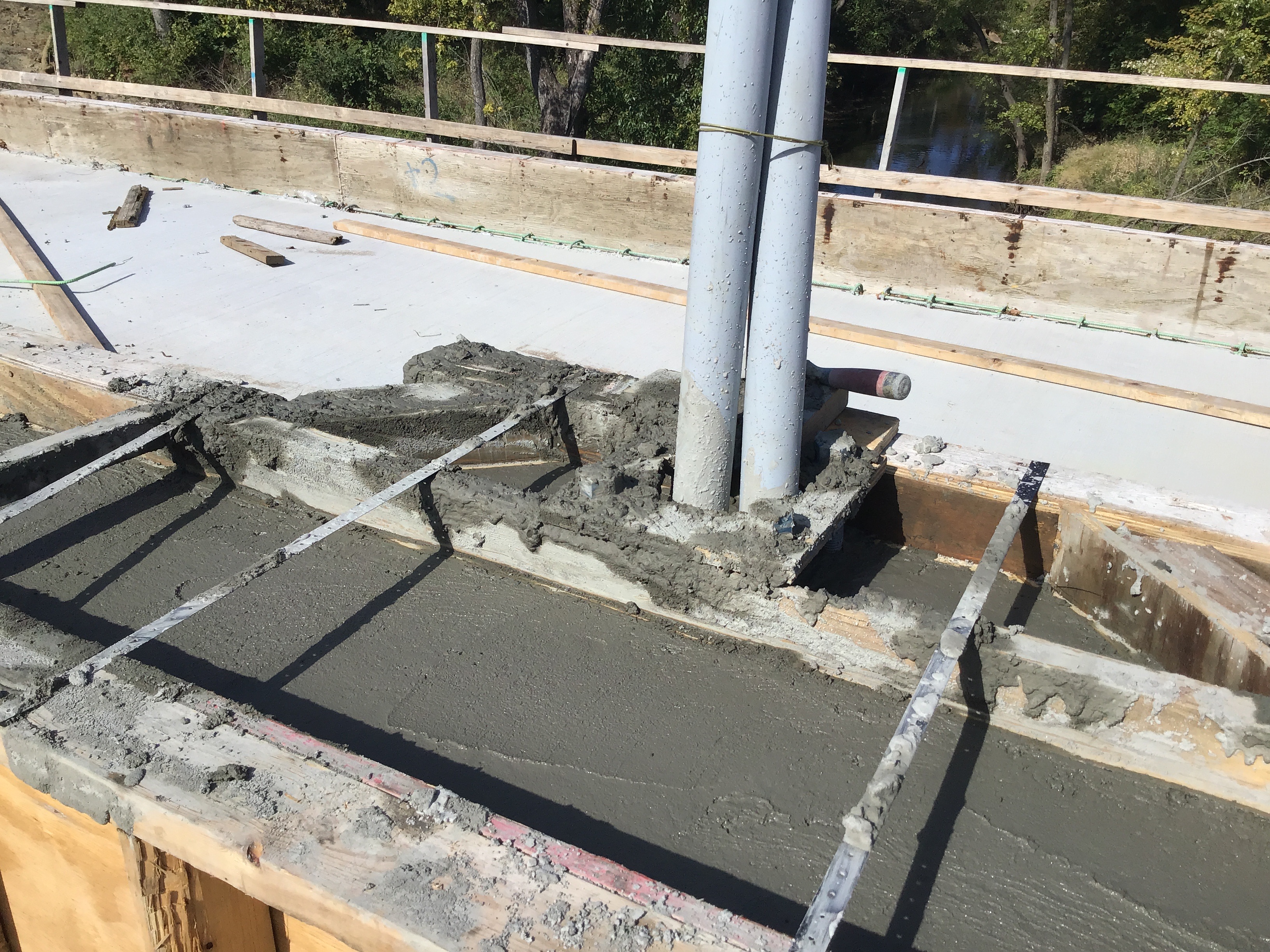

4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/12/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/12/2021

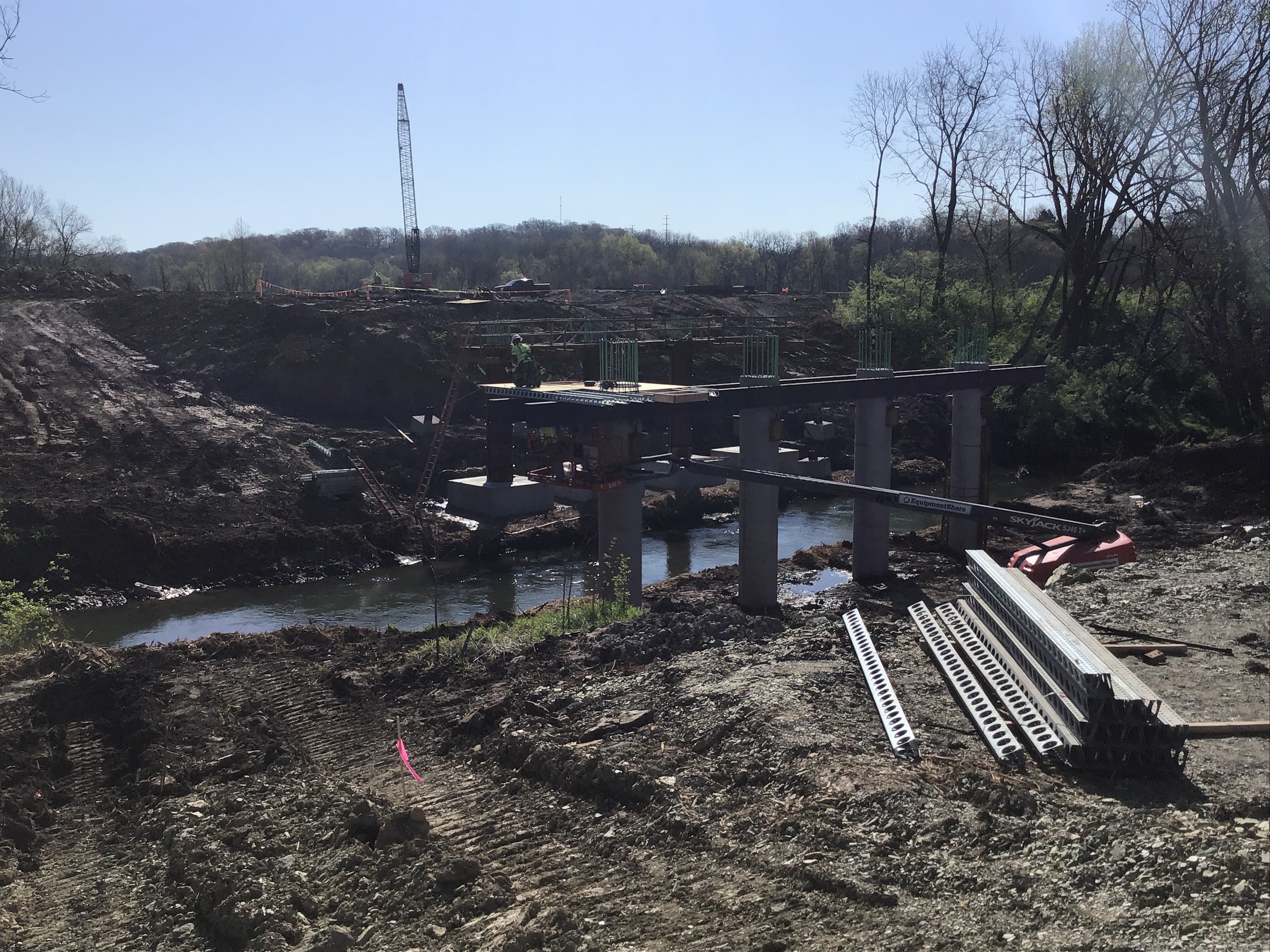

4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/12/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .

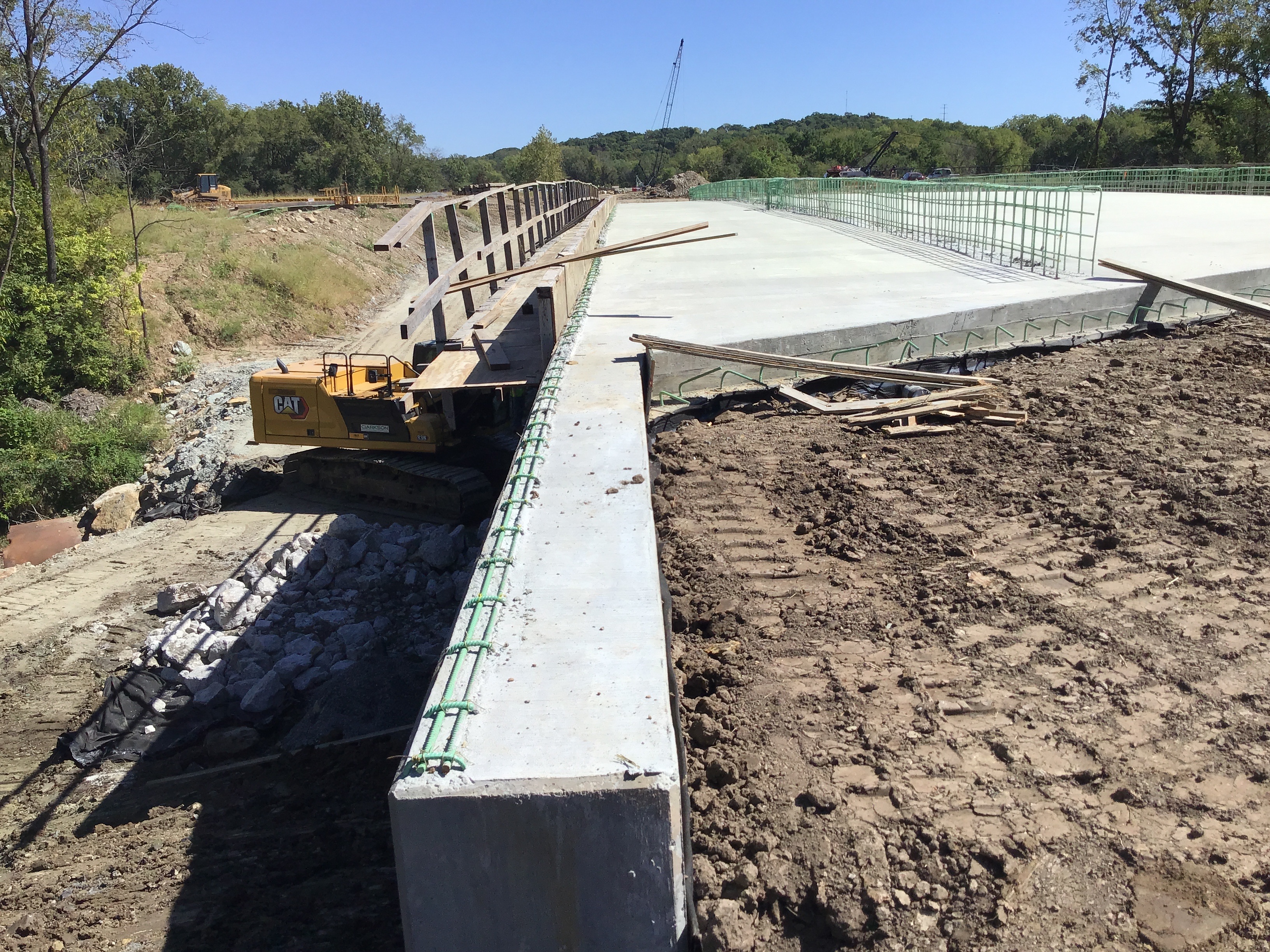

Misc
Informational
04/13/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Miscellaneous PWORKS Inspection Partial 04/14/2021
Misc
Informational
04/13/2021

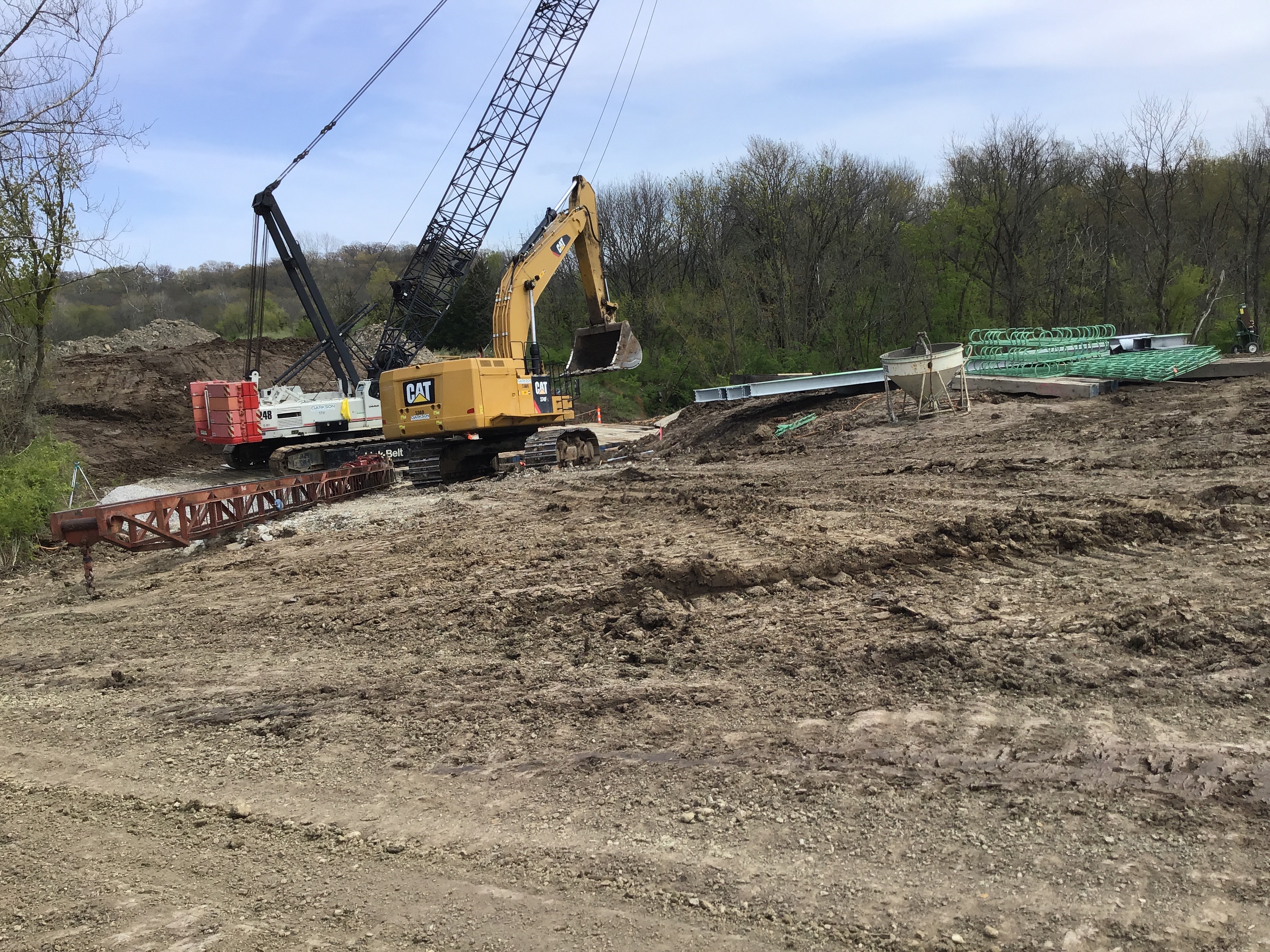

3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/13/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/13/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/13/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/13/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/13/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/13/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/13/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/13/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/14/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Water Line - Construction Inspection Partial 04/14/2021
Misc
Informational
03/31/2021
10/28/20 Wednesday Contractor has installed over 400’ of water main on Line D this was reported on PRSITE 20202246 . The Line D is connected with Line A it Tee of @ the Northside entrance of project off of View High Drive. Hydrant was installed @ Sta 03+97.31 and contractor continued to install water Line D.
Misc
Informational
03/31/2021
Misc
Informational
03/31/2021
3/9/21 Tuesday Contractor Chlorinated Line A & D to 03+70 @ 2:00PM. Contractor also corrected a leak that occurred to Line A around the air relief valve ( possibly leak due to the heavy truck and equipment coming through entrance area ). All were swab with chlorine and flushed.
Misc
Informational
03/31/2021
3/31/21 Wednesday Contractor ( Clarkson Gregg - crew ) has started working in the Lee’s boundary on water Line B. I will establish the approximate Station in future reports. 8” DIP water main is being installed as-per plan. The line connect to the Lee Summit side of the water main at View High Dr. and runs on the Northside of the road of View High Pkwy. Approximately 800 ft was is in the City of Kansas City Boundries.
Misc
Informational
04/14/2021
4/14/21 Wednesday Contractor (Clarkson - Gregg crew) rotated hydrants along View High Pkwy. They also rotated hydrants along Chipman Road (PRSUBD 20202246).
Miscellaneous PWORKS Inspection Partial 04/15/2021
Misc
Informational
04/14/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/14/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/14/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/14/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/14/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/14/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/14/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/14/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/14/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/14/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/15/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (EJ) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Miscellaneous PWORKS Inspection Partial 04/15/2021
Misc
Informational
04/15/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/15/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/15/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/15/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/15/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/15/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/15/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/15/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/15/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/15/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/15/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/15/2021

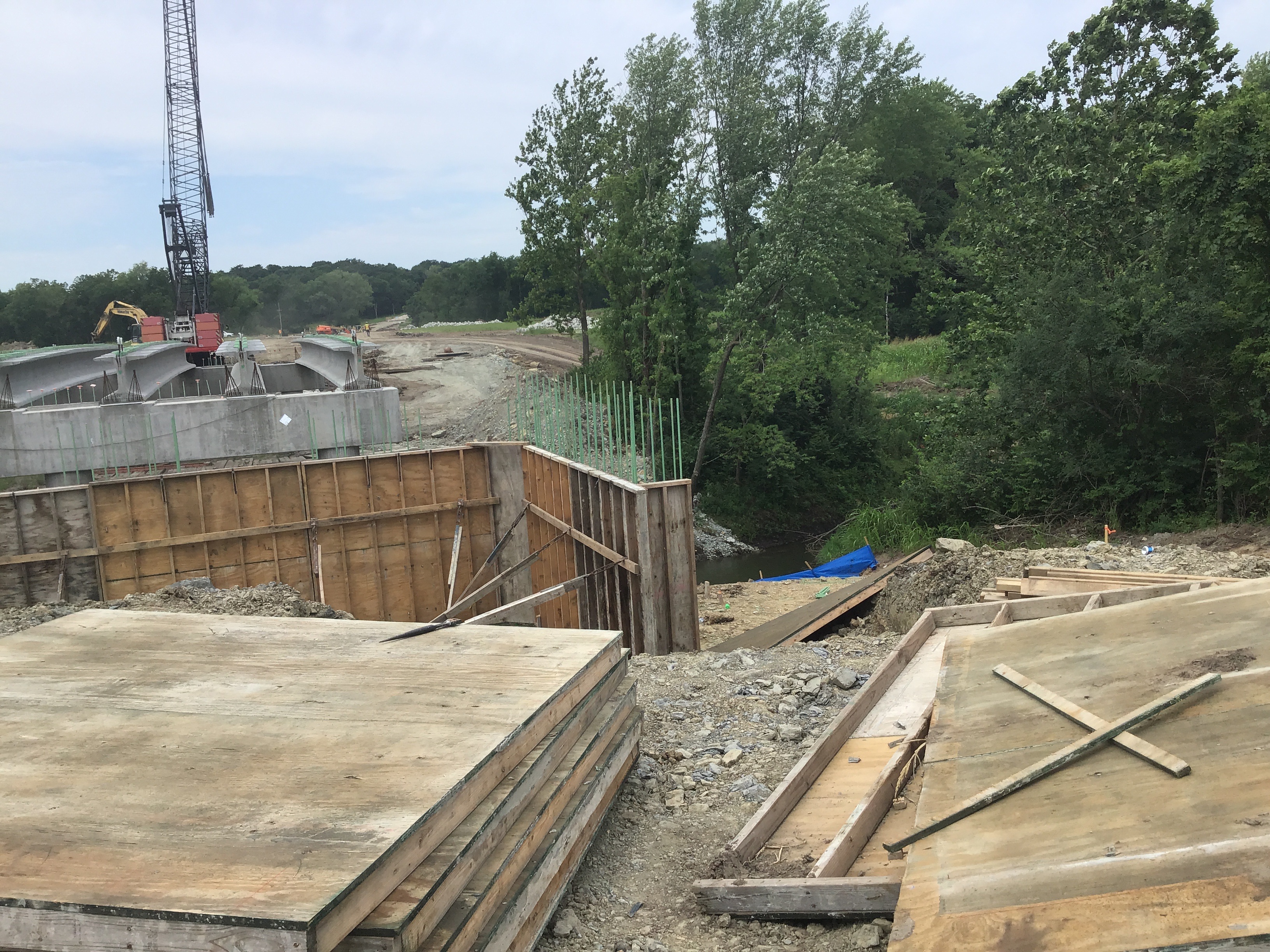

4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Water Line - Construction Inspection Partial 04/15/2021
Misc
Informational
04/14/2021
10/28/20 Wednesday Contractor has installed over 400’ of water main on Line D this was reported on PRSITE 20202246 . The Line D is connected with Line A it Tee of @ the Northside entrance of project off of View High Drive. Hydrant was installed @ Sta 03+97.31 and contractor continued to install water Line D.
Misc
Informational
04/14/2021
Misc
Informational
04/14/2021
3/9/21 Tuesday Contractor Chlorinated Line A & D to 03+70 @ 2:00PM. Contractor also corrected a leak that occurred to Line A around the air relief valve ( possibly leak due to the heavy truck and equipment coming through entrance area ). All were swab with chlorine and flushed.
Misc
Informational
04/14/2021
3/31/21 Wednesday Contractor ( Clarkson Gregg - crew ) has started working in the Lee’s boundary on water Line B. I will establish the approximate Station in future reports. 8” DIP water main is being installed as-per plan. The line connect to the Lee Summit side of the water main at View High Dr. and runs on the Northside of the road of View High Pkwy. Approximately 800 ft was is in the City of Kansas City Boundries.
Misc
Informational
04/14/2021
4/14/21 Wednesday Contractor (Clarkson - Gregg crew) rotated hydrants along View High Pkwy. They also rotated hydrants along Chipman Road (PRSUBD 20202246).
Misc
Informational
04/15/2021
4/15/21 Thursday Contractor (Clarkson - Gregg crew) de-chlorinated water main Line B that runs along View High Pkwy. I wittiness KCMO water main being de-chlorinated because connects to Lee’s Summit water main. See (PRSUBD 20202246) for chlorination.
Miscellaneous PWORKS Inspection Partial 04/19/2021
Misc
Informational
04/15/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/15/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/15/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/15/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/15/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/15/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/15/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/15/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/15/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/15/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/15/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/15/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/19/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Miscellaneous PWORKS Inspection Partial 04/21/2021
Misc
Informational
04/19/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/19/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/19/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/19/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/19/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/19/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/19/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/19/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/19/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/19/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/19/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/19/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/19/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/21/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Water Line - Coliform Test 1 Passed 04/21/2021
Misc
Informational
03/11/2021
3/11/21 Thursday Contractor ( Clarkson - Gregg crew ) collected samples from Line D & A . Line A permit #PRSUBD20202246.
Misc
Informational
04/21/2021
Water samples were taken on 4/19 it passed.
Miscellaneous PWORKS Inspection Partial 04/22/2021
Misc
Informational
04/21/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/21/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/21/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/21/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/21/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/21/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/21/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/21/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/21/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/21/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/21/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/21/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/21/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/21/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/22/2021
4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Miscellaneous PWORKS Inspection Partial 04/23/2021
Misc
Informational
04/22/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/22/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/22/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/22/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/22/2021

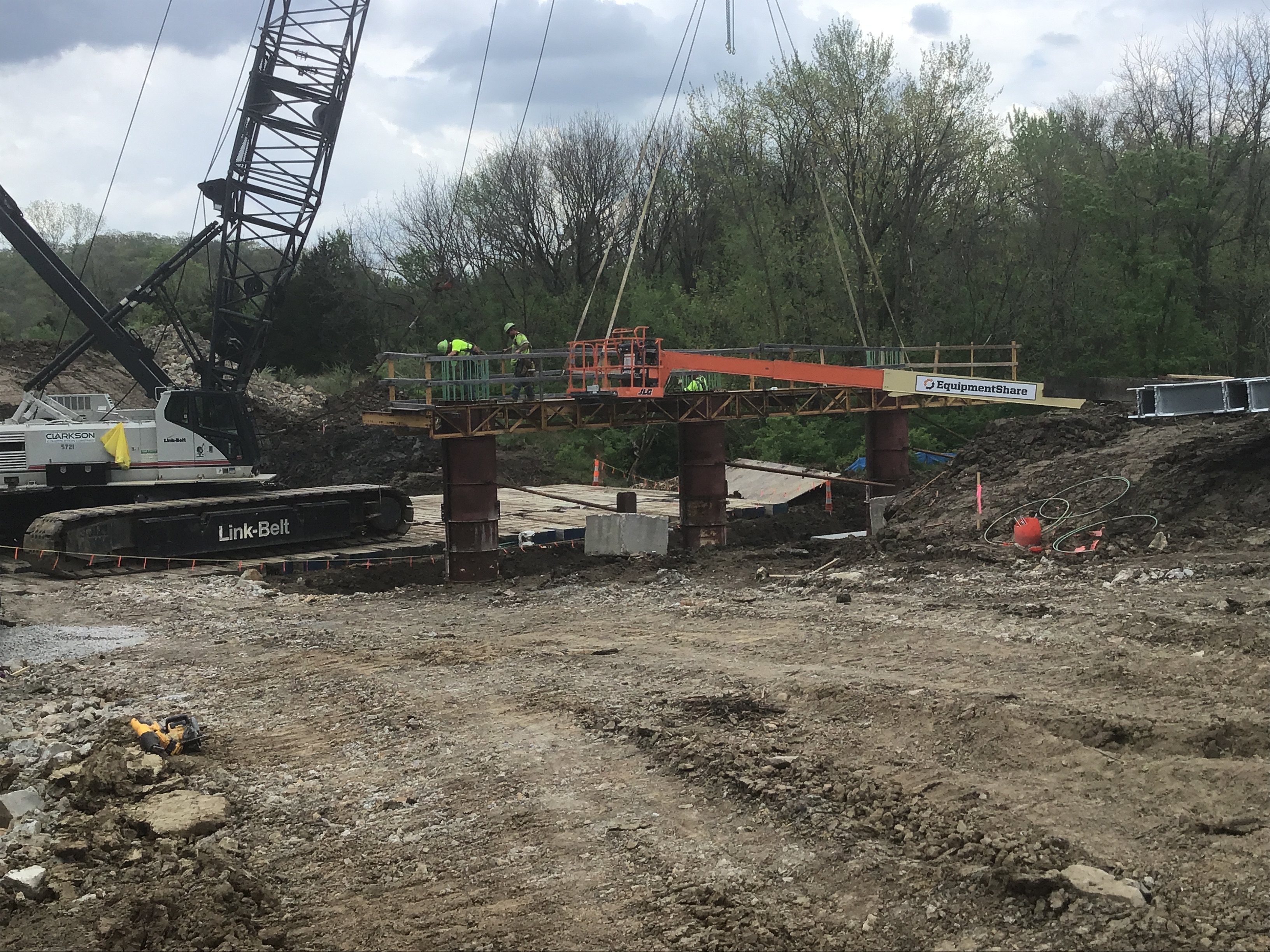

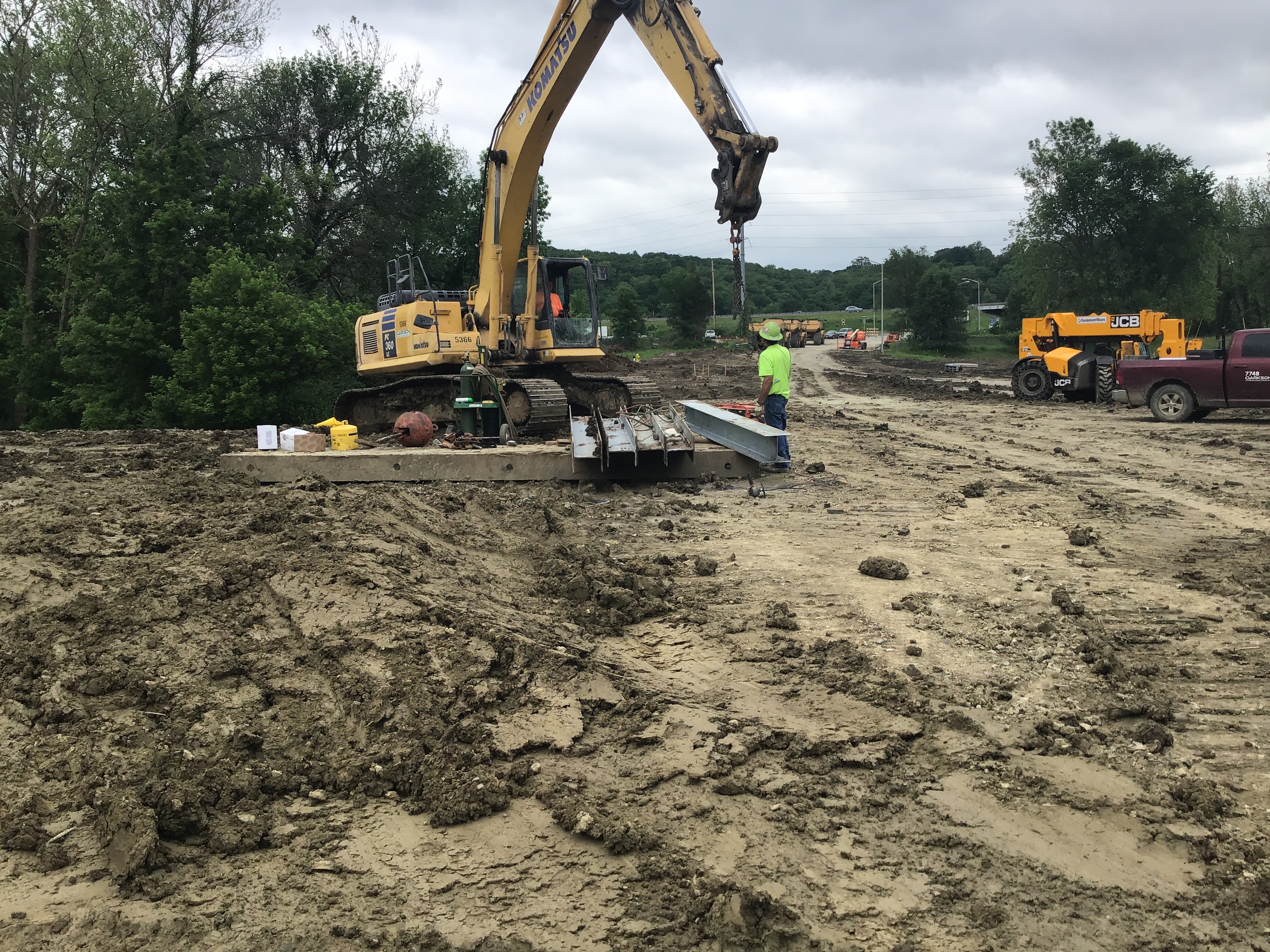

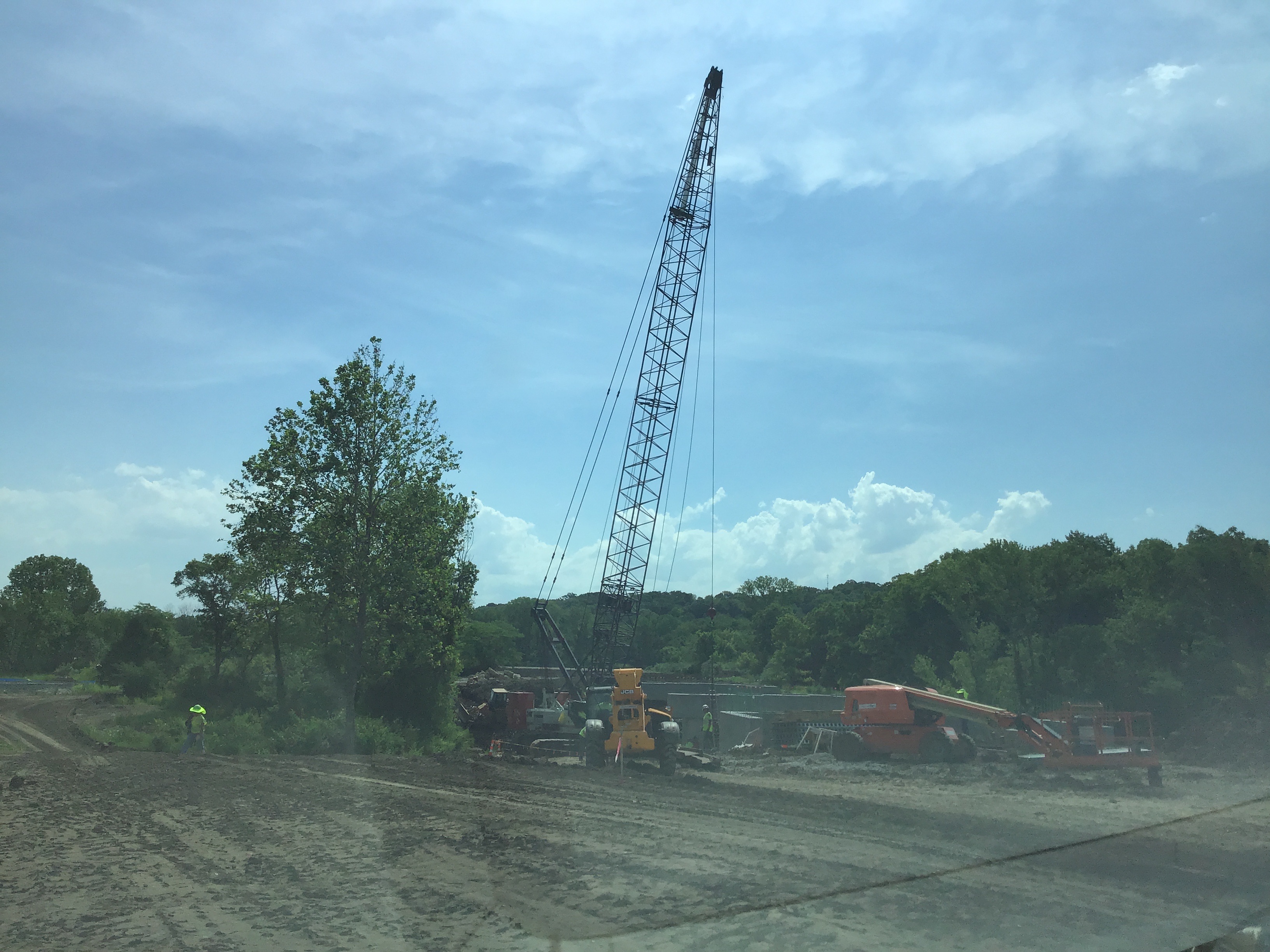

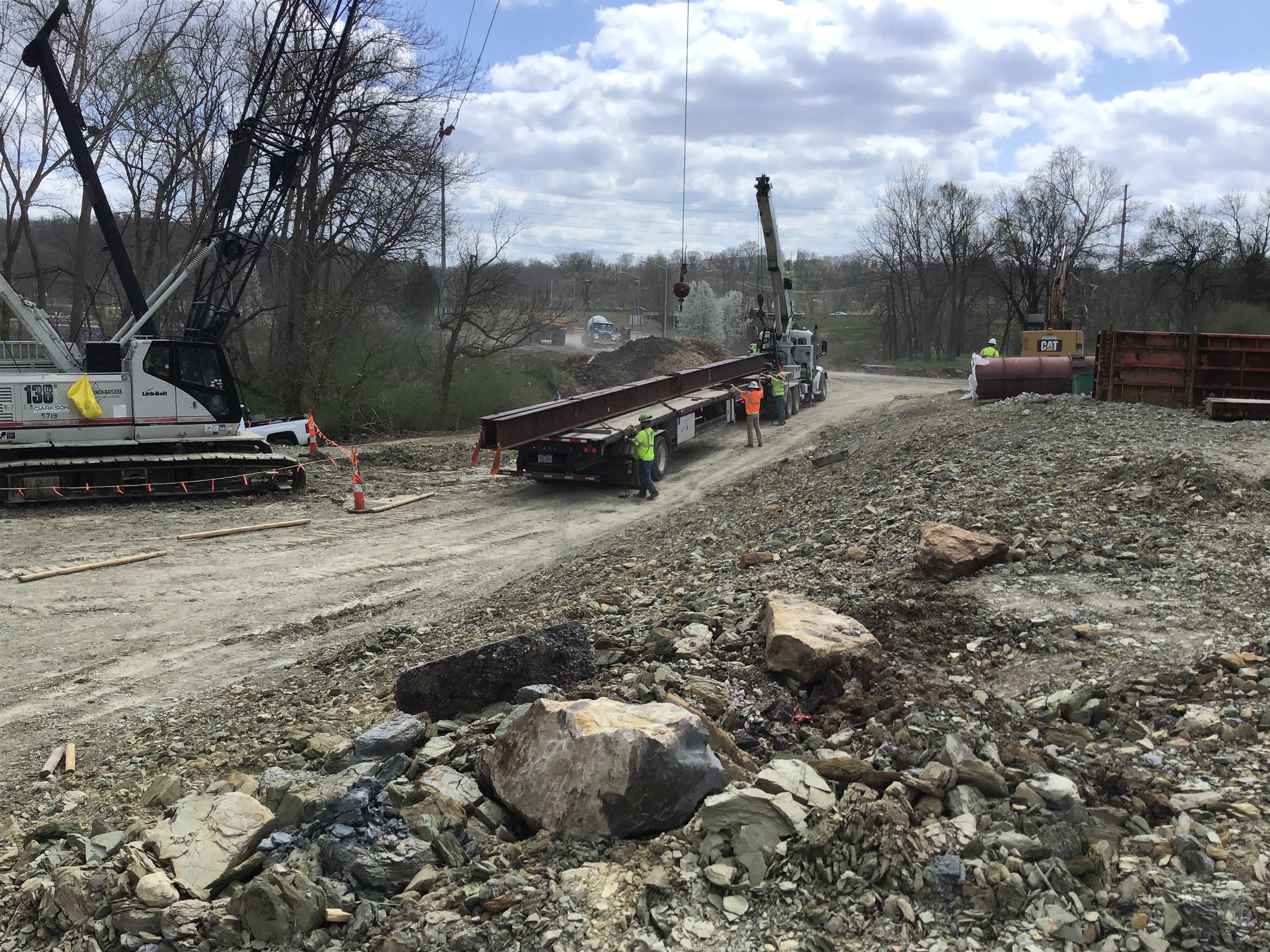

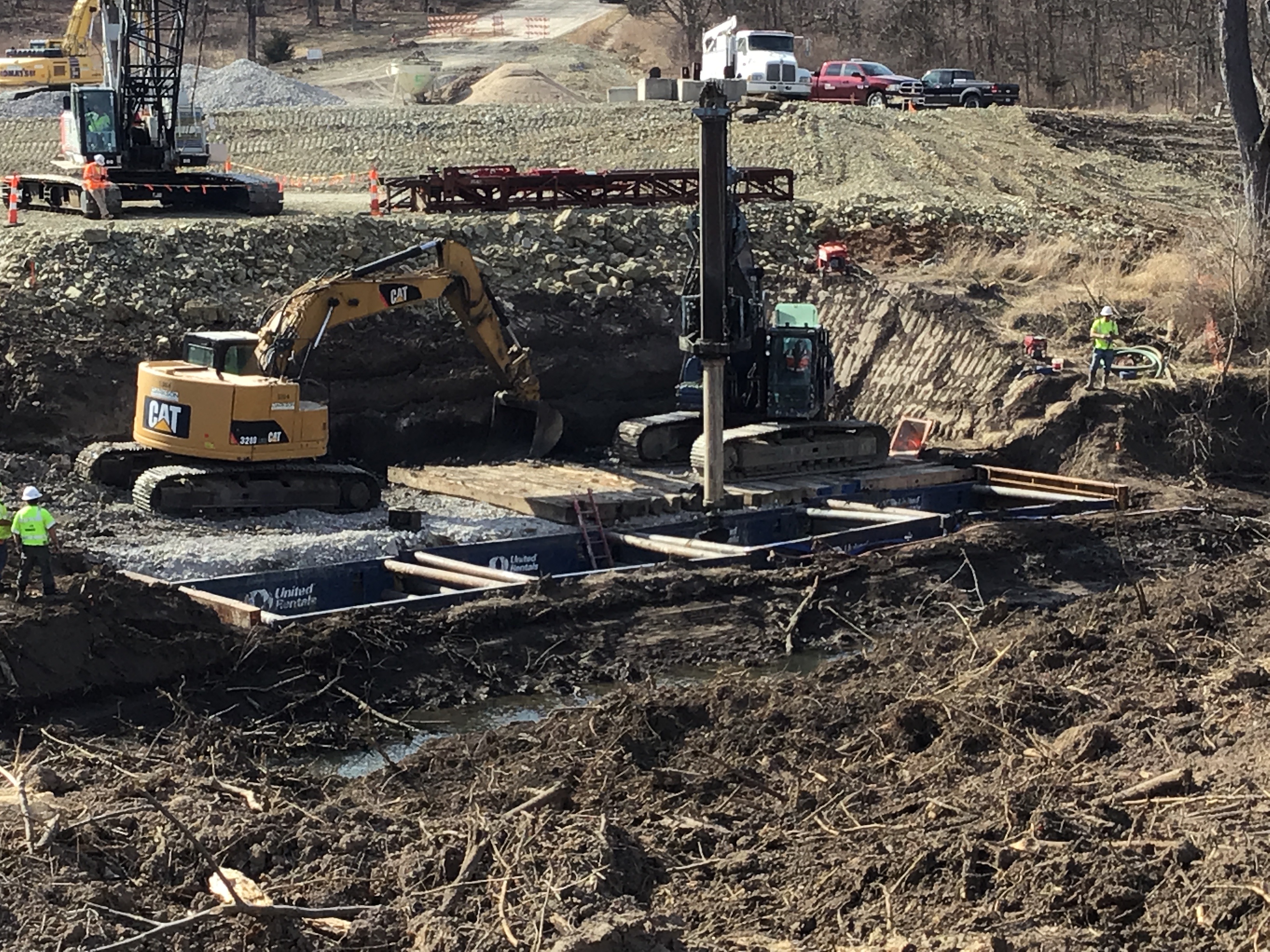

4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/22/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/22/2021

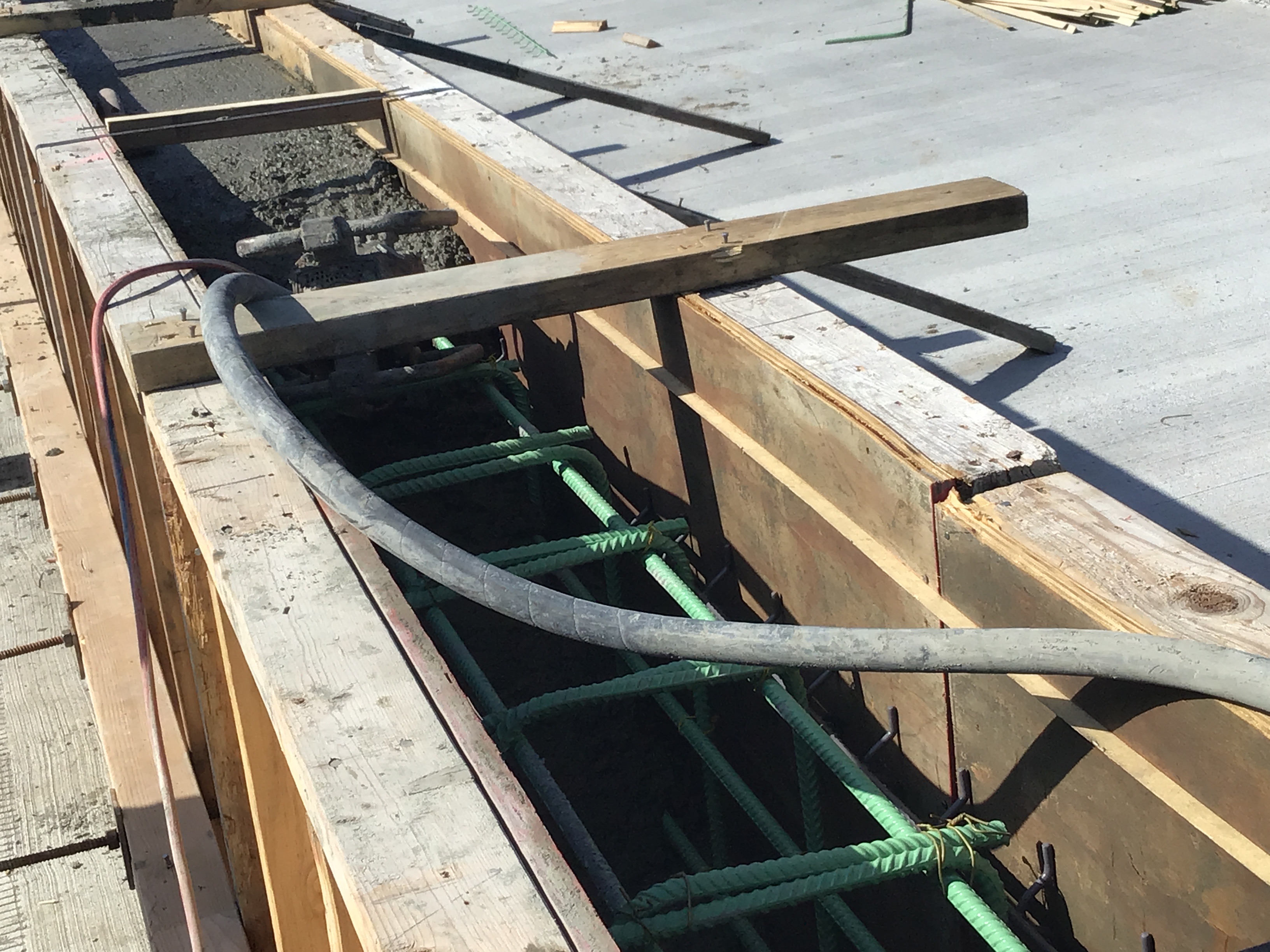

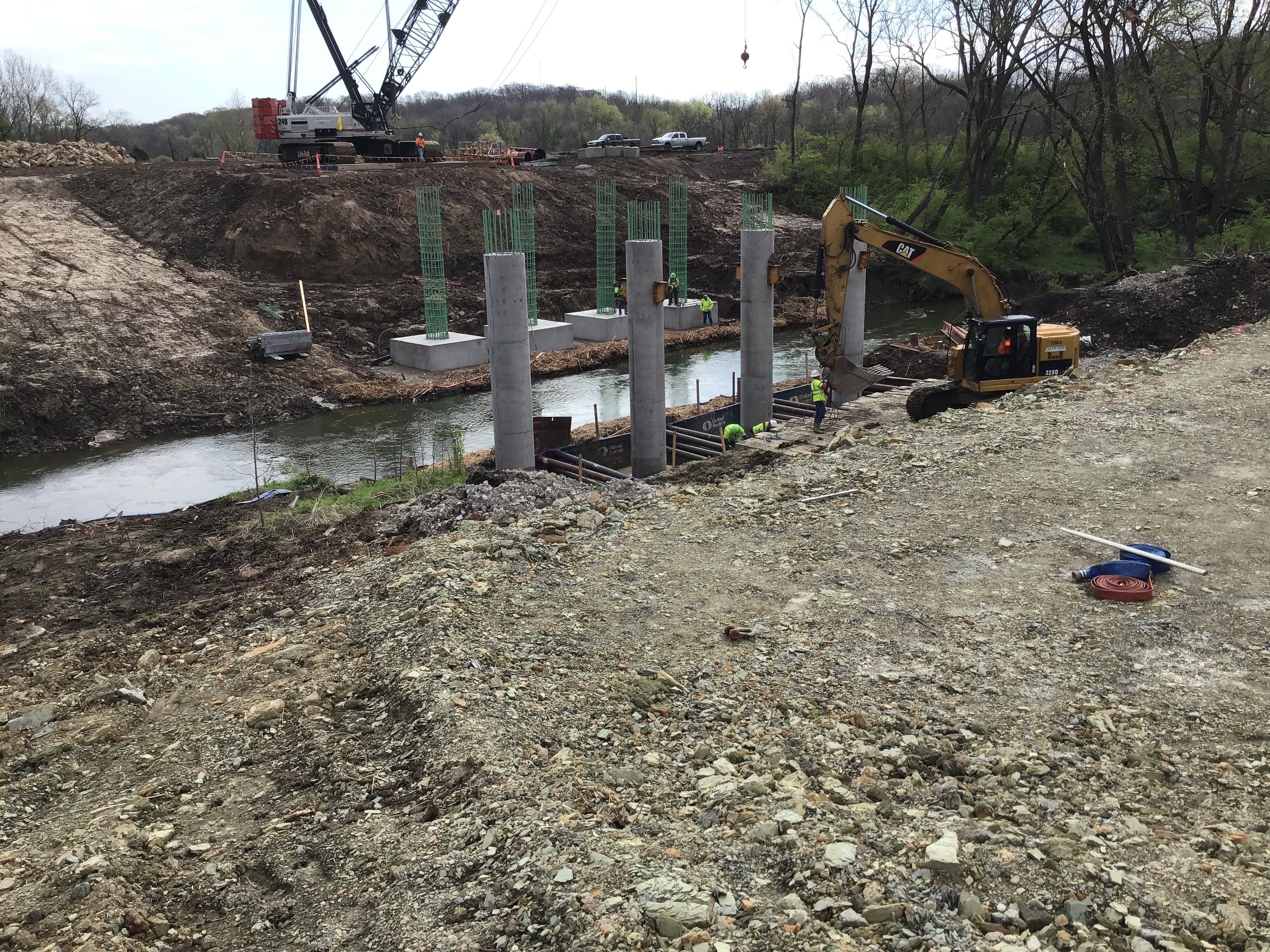

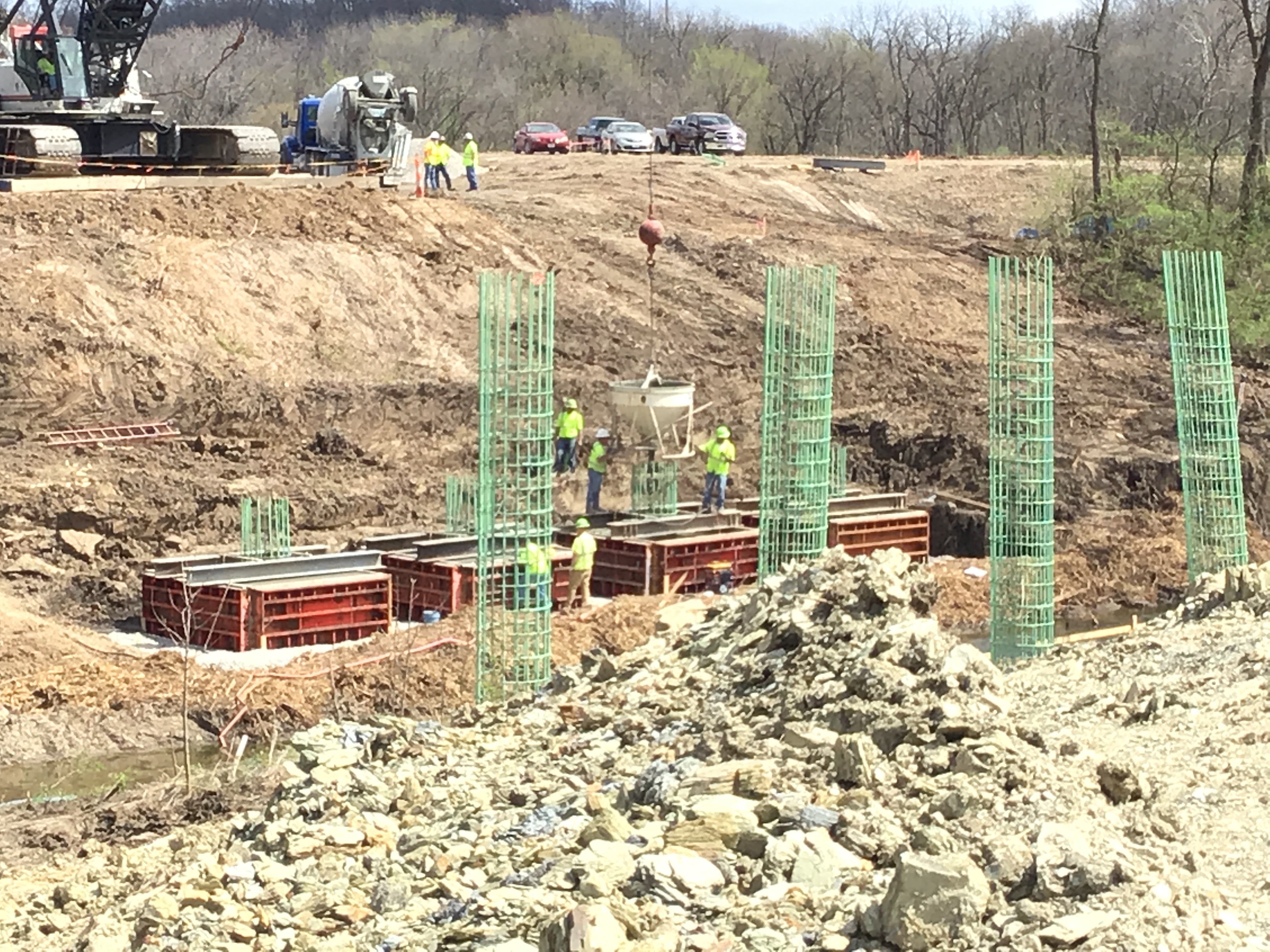

4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/22/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/22/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/22/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.

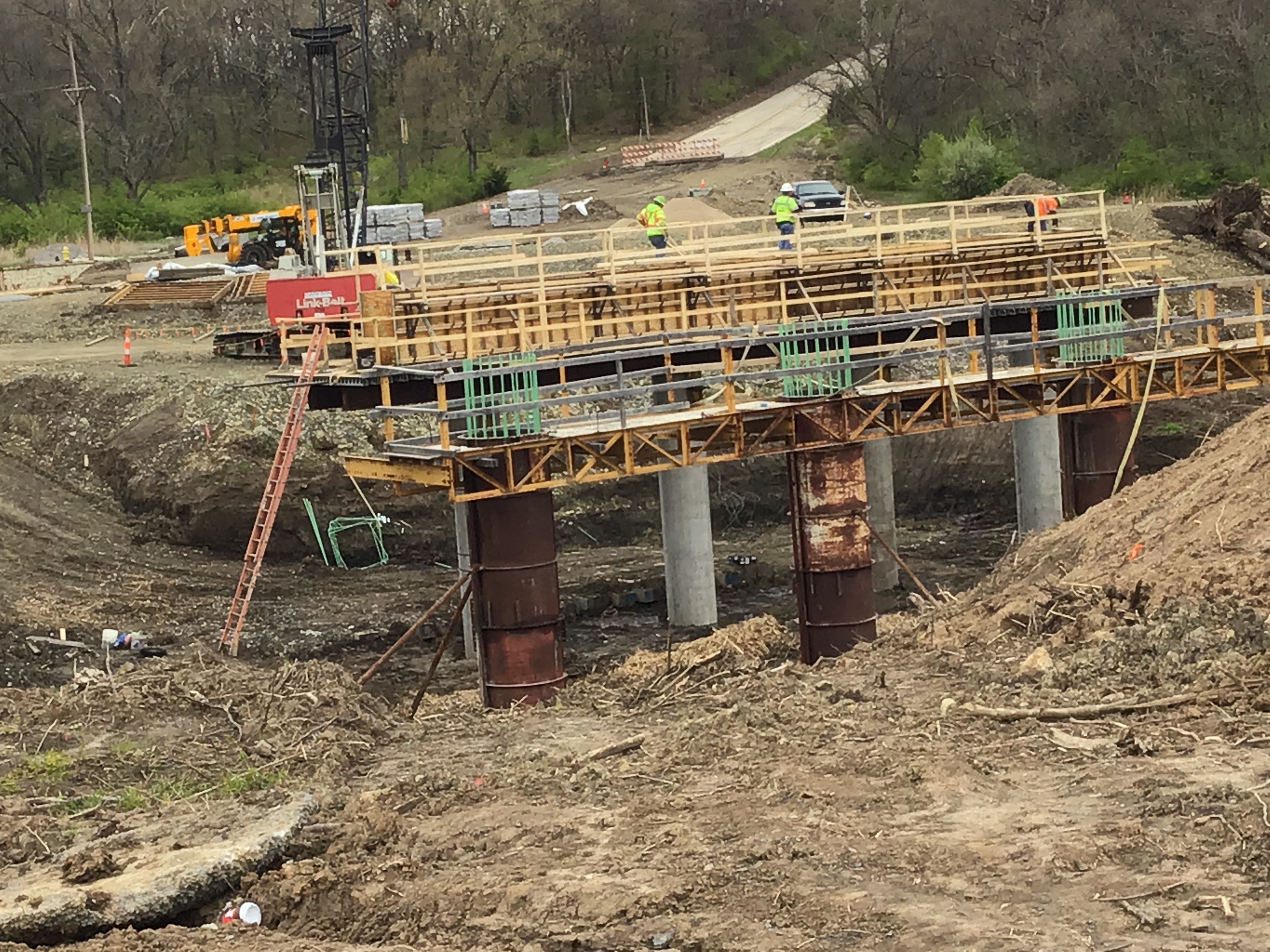

Misc
Informational
04/22/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/22/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/22/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/22/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/22/2021

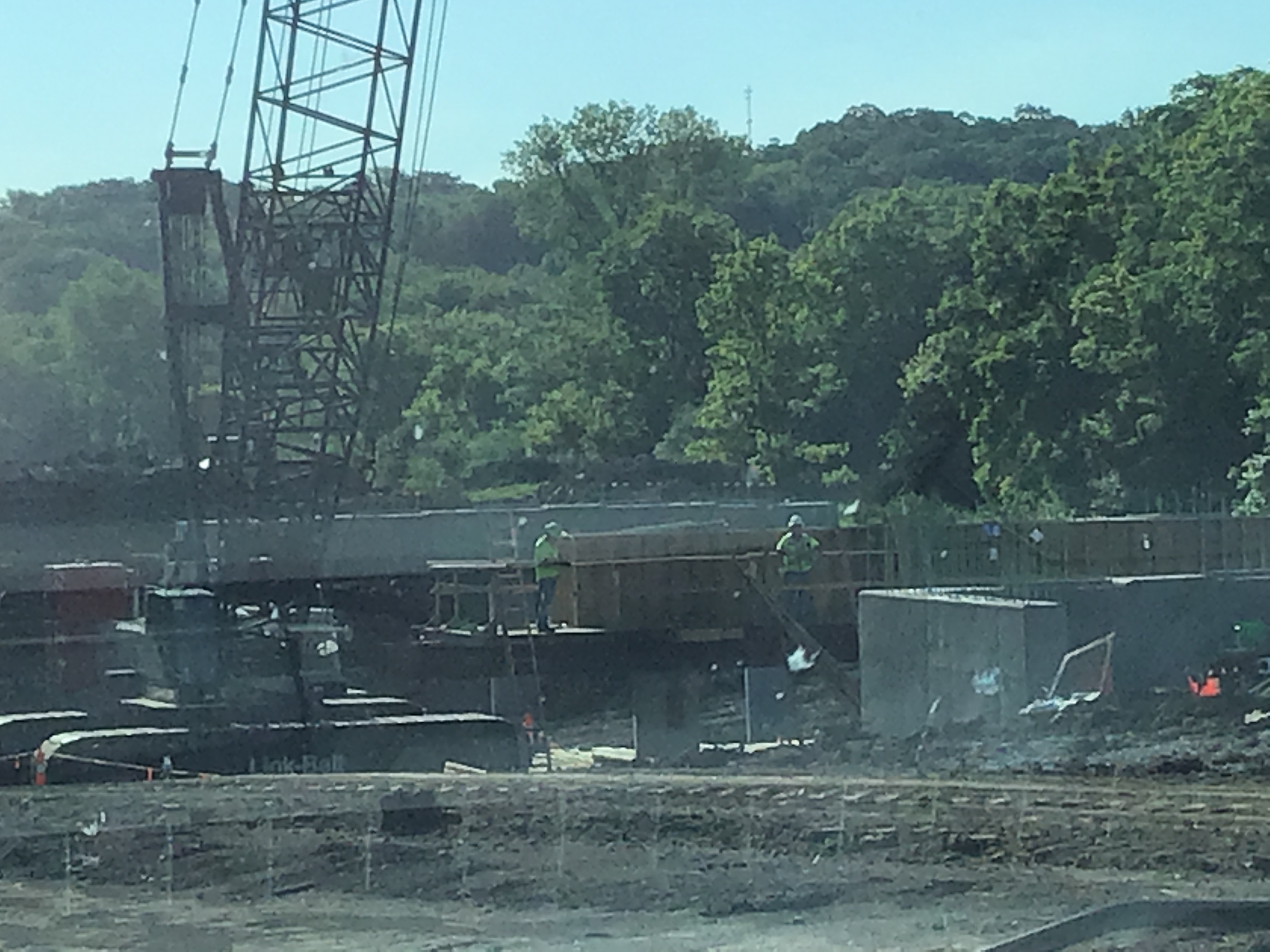

4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Misc
Informational
04/23/2021
The Date for yesterday report should have read 4/22/21 Thursday. Today Bridge crews worked on West & East Bridge contractor continued to build for the Cap Bent 2 and the East Bridge on Bent 3 continued to frame for Footings to drive piles. Footings were poured yesterday and today on East Bridge for Bent 2.
Miscellaneous PWORKS Inspection Partial 04/26/2021
Misc
Informational
04/23/2021

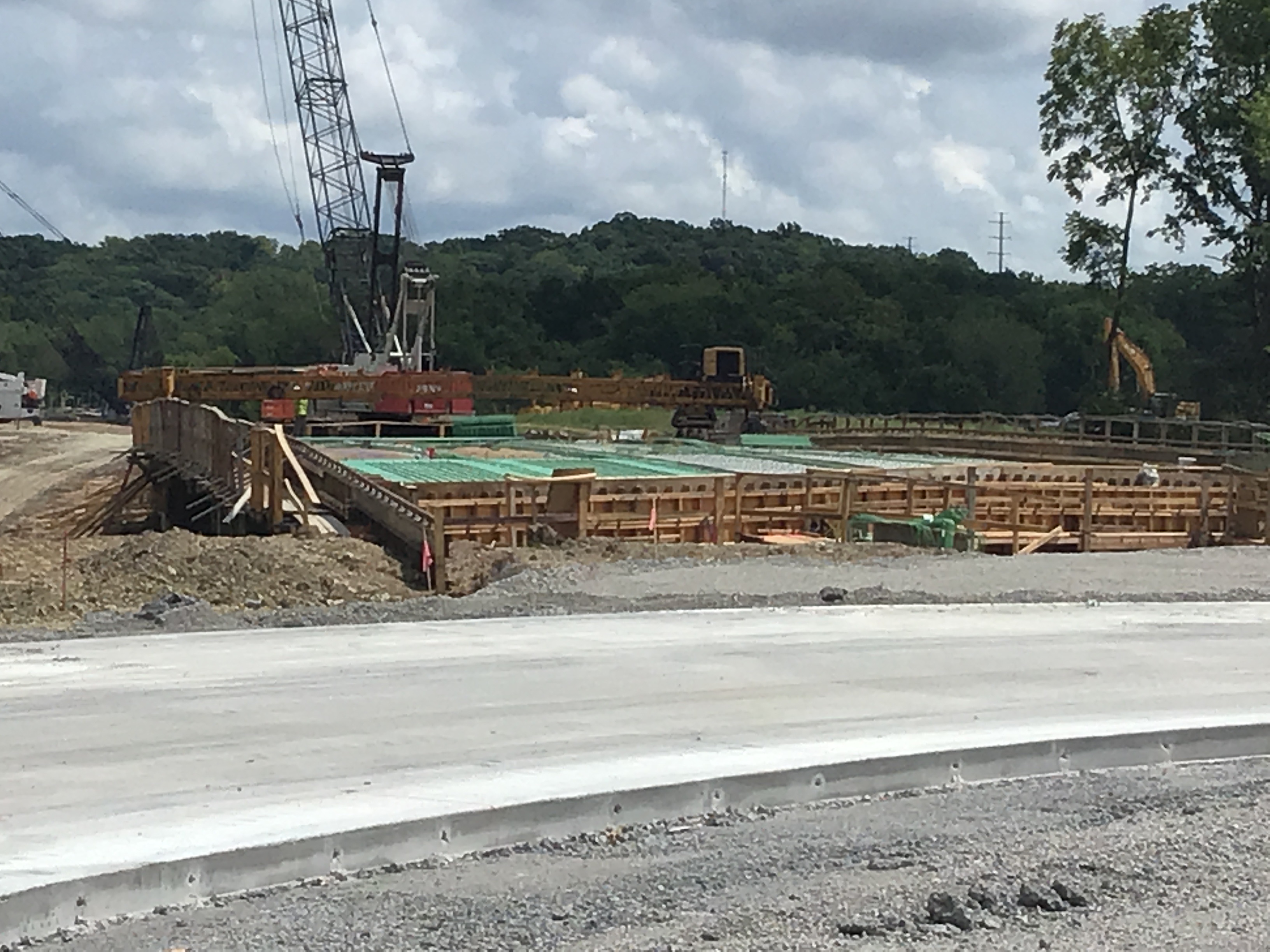

3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/23/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/23/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/23/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/23/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/23/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/23/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/23/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/23/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/23/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/23/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/23/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/23/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/23/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/23/2021
4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Misc
Informational
04/23/2021
The Date for yesterday report should have read 4/22/21 Thursday. Today Bridge crews worked on West & East Bridge contractor continued to build for the Cap Bent 2 and the East Bridge on Bent 3 continued to frame for Footings to drive piles. Footings were poured yesterday and today on East Bridge for Bent 2.
Misc
Informational
04/26/2021

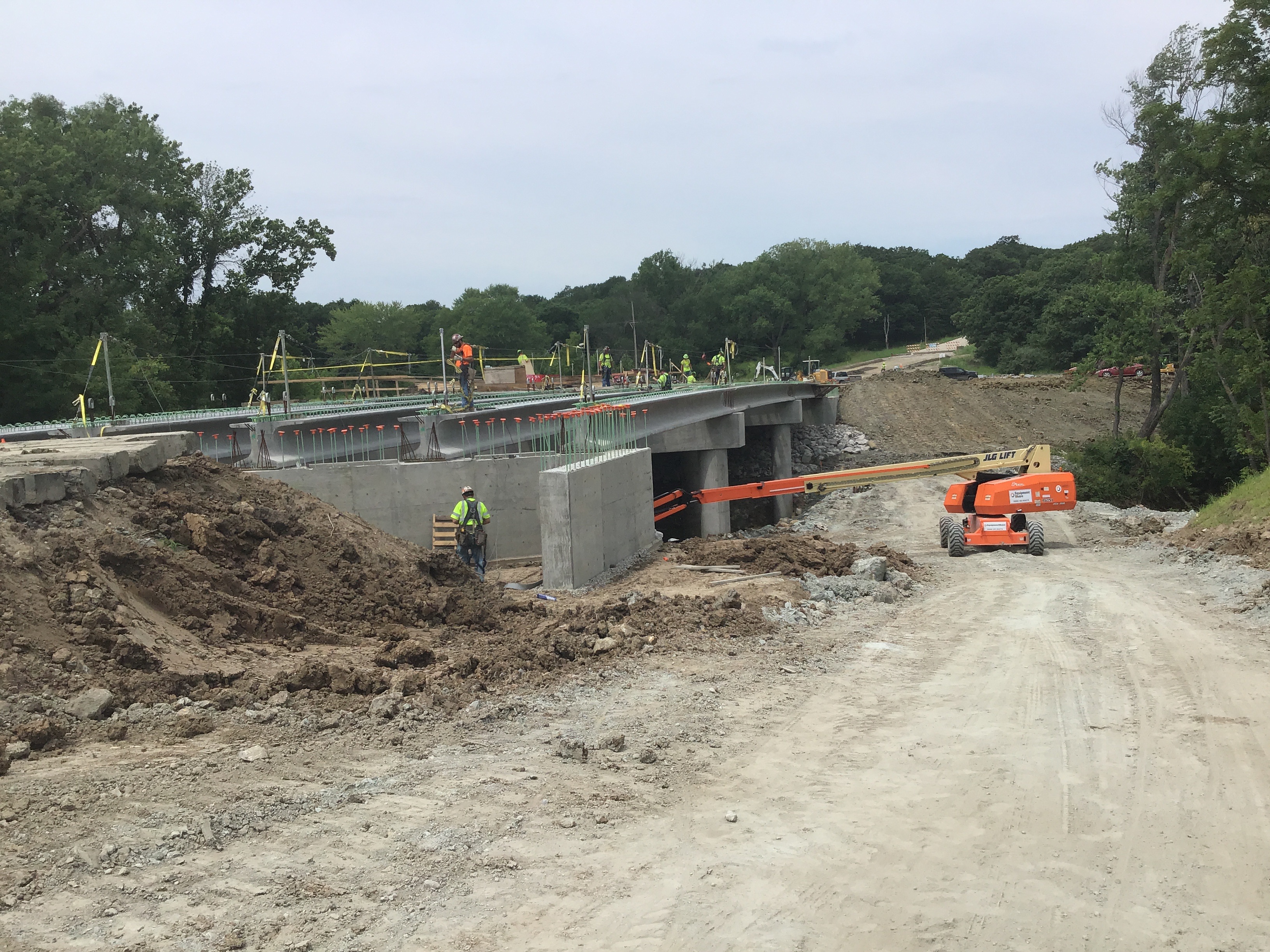

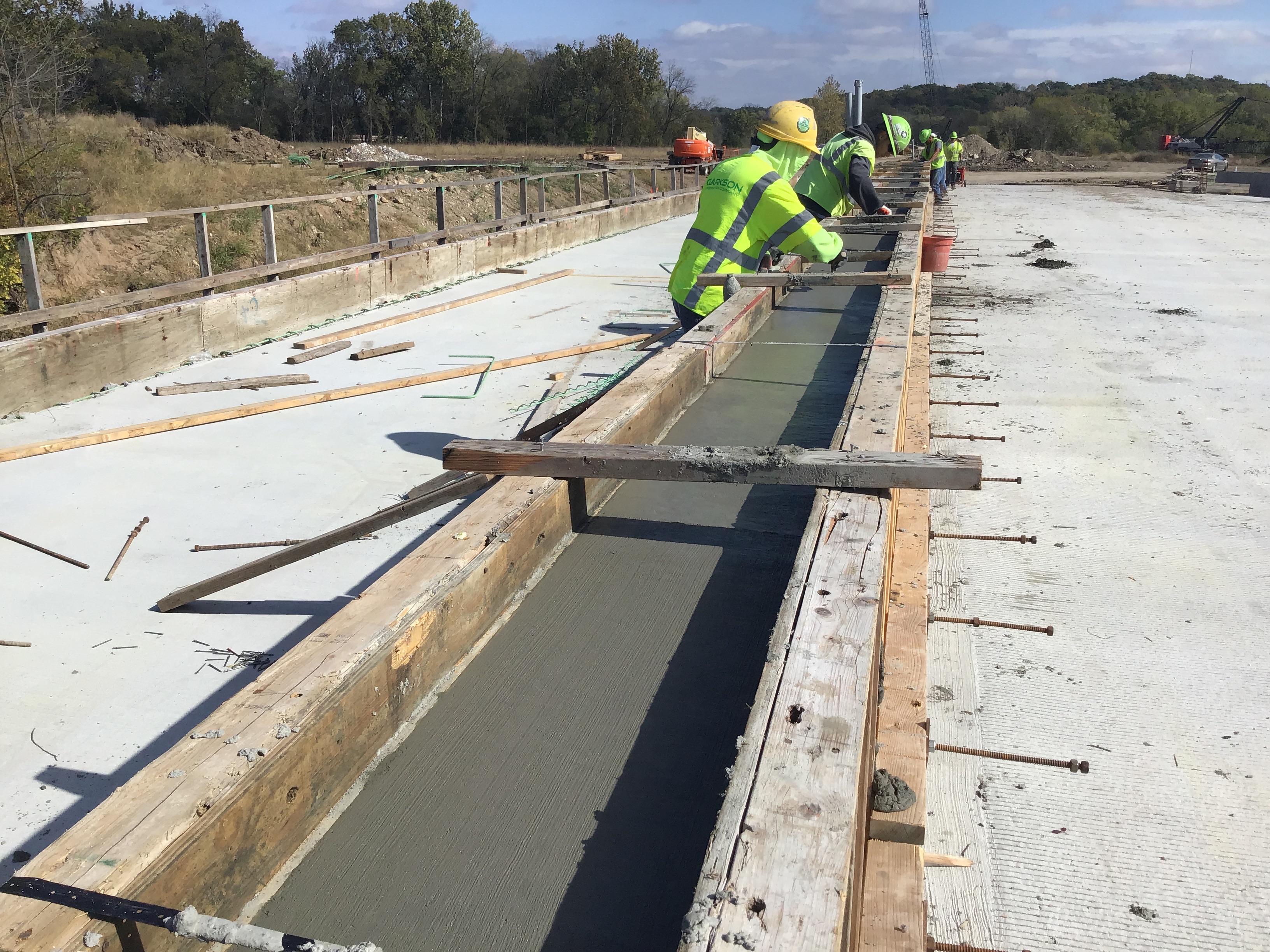

4/26/21 Monday West Bridge @ Bent 2 contractor began pouring concrete into forms for Cap. East Bridge contractor continued to construct metal form to drive piles and pour fittings @ Bent 3.
Miscellaneous PWORKS Inspection Partial 04/27/2021
Misc
Informational
04/26/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/26/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/26/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/26/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/26/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/26/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/26/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/26/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/26/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/26/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/26/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/26/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/26/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/26/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/26/2021
4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Misc
Informational
04/26/2021
The Date for yesterday report should have read 4/22/21 Thursday. Today Bridge crews worked on West & East Bridge contractor continued to build for the Cap Bent 2 and the East Bridge on Bent 3 continued to frame for Footings to drive piles. Footings were poured yesterday and today on East Bridge for Bent 2.
Misc
Informational
04/26/2021
4/26/21 Monday West Bridge @ Bent 2 contractor began pouring concrete into forms for Cap. East Bridge contractor continued to construct metal form to drive piles and pour fittings @ Bent 3.
Misc
Informational
04/27/2021

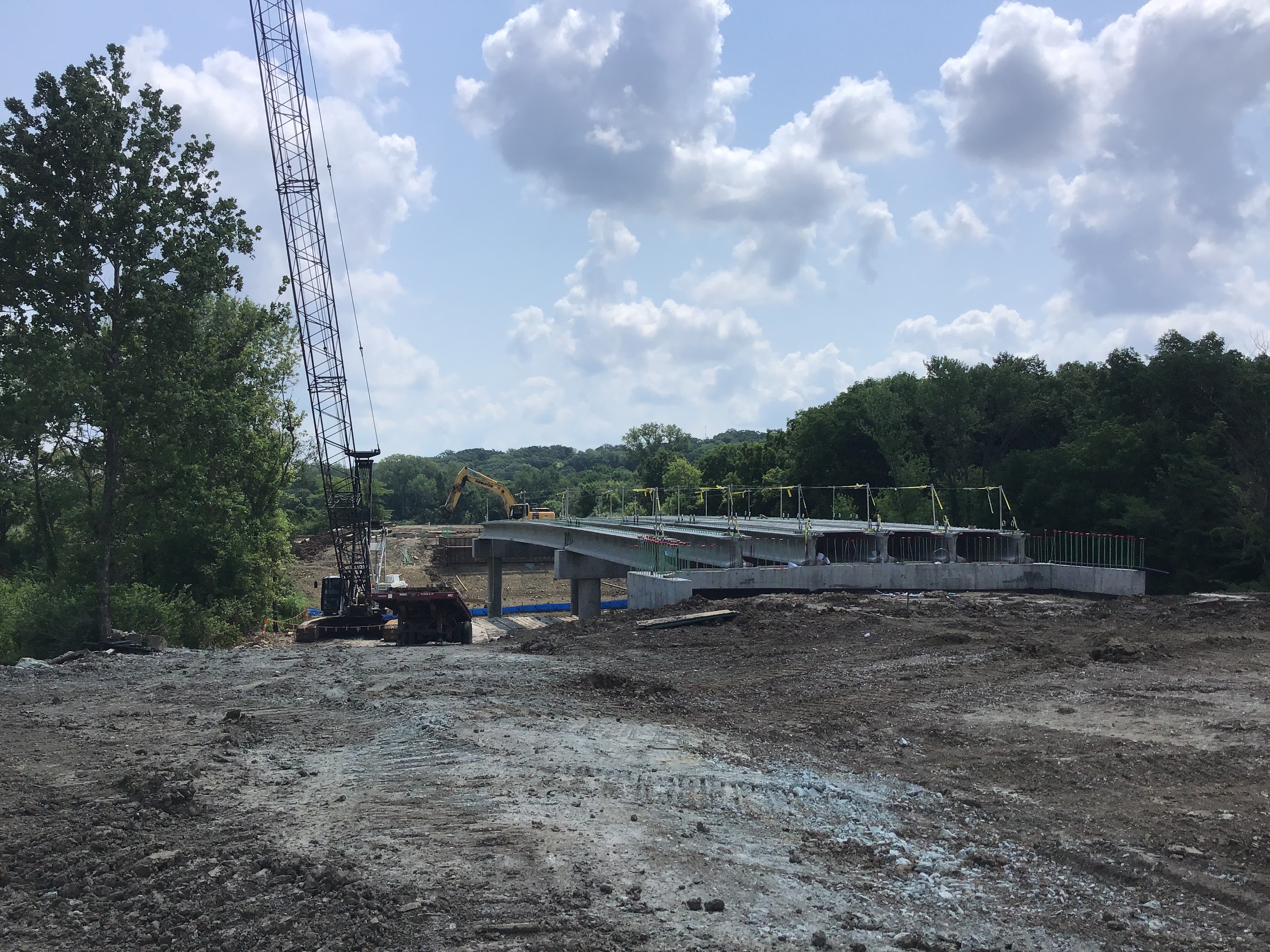

4/27/21 Tuesday West Bridge @ Bent 3 contractor removed metal forms for columns and East Bridge @ Bent 3 contractor continued to form structures.
Miscellaneous PWORKS Inspection Partial 04/28/2021
Misc
Informational
04/27/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/27/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/27/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/27/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/27/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/27/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/27/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/27/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/27/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/27/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/27/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/27/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/27/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/27/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/27/2021
4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Misc
Informational
04/27/2021
The Date for yesterday report should have read 4/22/21 Thursday. Today Bridge crews worked on West & East Bridge contractor continued to build for the Cap Bent 2 and the East Bridge on Bent 3 continued to frame for Footings to drive piles. Footings were poured yesterday and today on East Bridge for Bent 2.
Misc
Informational
04/27/2021
4/26/21 Monday West Bridge @ Bent 2 contractor began pouring concrete into forms for Cap. East Bridge contractor continued to construct metal form to drive piles and pour fittings @ Bent 3.
Misc
Informational
04/27/2021
4/27/21 Tuesday West Bridge @ Bent 3 contractor removed metal forms for columns and East Bridge @ Bent 3 contractor continued to form structures.
Misc
Informational
04/28/2021

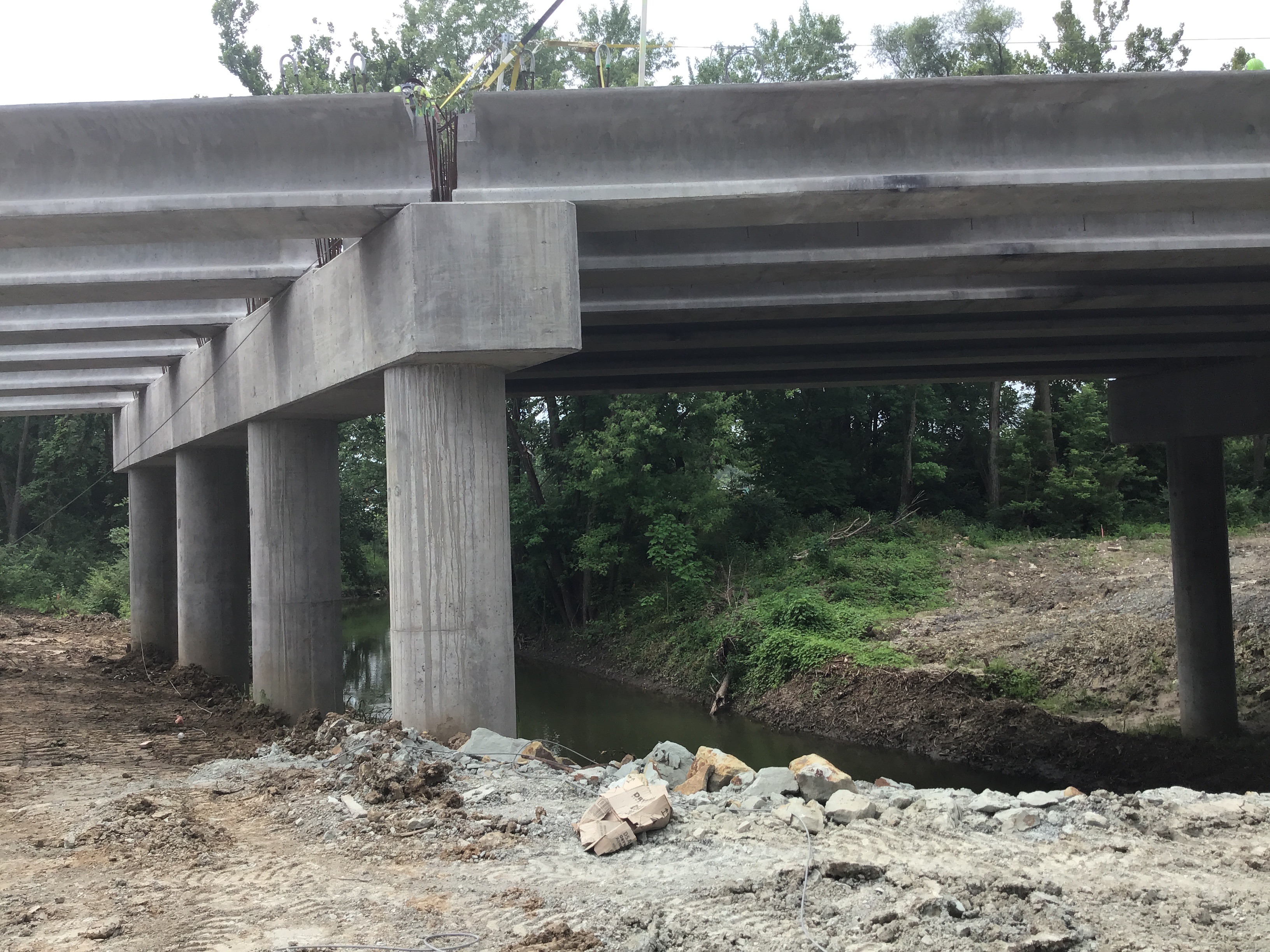

4/28/21 Wednesday West Bridge @ Bent 2 contractor removed frame from Cap and at the East Bridge @ Bent 2 contractor is installing rebar columns. 4/29/21 Thursday East Bridge @ Bent 3 contractor drilled holes to depth specified by plans. Due to ground condition because of the rains yesterday evening work focused on equipment preparation for bridge construction. 4/30/21 Friday East Bridge @ Bent 2 columns were poured & Bent 3 contractor work to prepare for driving piles.
Miscellaneous PWORKS Inspection Partial 05/03/2021
Misc
Informational
04/28/2021
3/30/21 Tuesday Contractor ( Bridge- crew) has completed driving the piles into place until (Refusal) Olsson was there to observe as a third party and required verification of bridge construction 3/26 to 3/29. Rebar was installed for the footing and concrete was poured for construction of footing on Bent NO. 2. All four footings were poured on 3/30/21 as per plan see page 7 of 30.
Misc
Informational
04/28/2021
3/31/21 Wednesday Contractor (Bridge crew) working to install forms for Bent 3 due to concern for upcoming inclement weather conditions. Clearing area to set platform for the beginning of construction on the Eastside of waterway. Contractor mark forms and materials for the pouring of columns on Bent 2.
Misc
Informational
04/28/2021
4/1/21 Thursday Contractor (Bridge crew) began hammering pile to Refusal around 10:00 AM, for Bent 3 in the marked area. This process will continue until all piles are completed as per project plans.
Misc
Informational
04/28/2021
4/1/21 Thursday Contractor (Bridge crew) was able to hammer piles to Refusal until 3:20PM, for Bent 3 in designated area as-per project plans. 13 piles were installed in total. See project photos for the day.
Misc
Corrective Action Required
04/28/2021
4/2/21 Friday Contractor (Bridge crew) hammered three more piles for a ( total of 16 piles or 8 pairs of piles ) @ Bent 3, the contractor cut off the extra length from piles too the proper height as-per plan.
Misc
Informational
04/28/2021
4/5/21 Monday Contractor (Clarkson - Bridge crew) installed forms, base footing,& framing rebar for columns.
Misc
Informational
04/28/2021
4/6/21 Tuesday Contractor (Clarkson - Bridge crew) poured the columns for Bent 2 as-per project plans.
Misc
Informational
04/28/2021
4/12/21 Monday Contractor (Clarkson - Bridge crew) completed the formed of rebar for columns on Bent 3. Contractor will remove shoring trench boxes from Bent 2 and prepare rafter section that sit on top of columns to construct bridge. Contractor may pour concrete columns on Bent 3 on 4/14/21 Wednesday .
Misc
Informational
04/28/2021
4/13/21 Tuesday Contractor (Clarkson - Bridge crew) Bent 3 set up scaffolding for bridge construction.
Misc
Informational
04/28/2021
4/14/21 Wednesday Contractor ( Clarkson - Bridge crew) constructed forms for Toe Wall on storm Line 100 on 4/13/21. Columns for Bent 3 were poured today and Toe Wall on Storm Line 100.
Misc
Informational
04/28/2021
4/15/21 Thursday (Clarkson - Bridge crew) continues to install bridge support materials to construct bridge @ Bent 2. (E) anchors and plywood form boards were set in place to allow further installation of rebar as-per project plans.
Misc
Informational
04/28/2021
4/15/21 Thursday Contractor (Clarkson - Bridge crew) continued to construct support platforms on Bent 2 and 3.
Misc
Informational
04/28/2021
4/19/21 Monday Contractor (Clarkson - Bridge crew) continued to construct rebar for Cap on Bent 2 columns.
Misc
Informational
04/28/2021
4/21/21 Wednesday Contractor (Clarkson - Bridge crew) began driving piles in for the East Bridge @ Bent 2. Olsson was at the site as a third party inspector to witness and recorded piles being driven to failure. Contractor has (e-mail was sent out today, they called to notify inspector (John M. Jackson) as Lee’s Summit Engineer Department required) received permission to build a path across waterway for the West bridge. Contractor continues to construct rebar for the Cap across columns.
Misc
Informational
04/28/2021
4/21/21 Thursday Contractor continued to work on framing for concrete pours on West Bridge for Bent 2&3, and I replied to Kevin Brandon/ Project Assistant Fogel-Anderson Construction Co. about the e-mail that approved the plans for water crossing at the West Bridge. East Bridge contractor continued to prep east bank for piles and general work on bridge construction.
Misc
Informational
04/28/2021
The Date for yesterday report should have read 4/22/21 Thursday. Today Bridge crews worked on West & East Bridge contractor continued to build for the Cap Bent 2 and the East Bridge on Bent 3 continued to frame for Footings to drive piles. Footings were poured yesterday and today on East Bridge for Bent 2.
Misc
Informational
04/28/2021
4/26/21 Monday West Bridge @ Bent 2 contractor began pouring concrete into forms for Cap. East Bridge contractor continued to construct metal form to drive piles and pour fittings @ Bent 3.
Misc
Informational
04/28/2021
4/27/21 Tuesday West Bridge @ Bent 3 contractor removed metal forms for columns and East Bridge @ Bent 3 contractor continued to form structures.
Misc
Informational
04/28/2021
4/28/21 Wednesday West Bridge @ Bent 2 contractor removed frame from Cap and at the East Bridge @ Bent 2 contractor is installing rebar columns. 4/30/21 Thursday East Bridge @ Bent 2 contractor poured concrete for columns. Contractor will drive piles a@ Bent 3 on Monday 5/3/21. 5/3/21 Monday East Bridge @ Bent 3 @ 11:00am bridge crew began to drive piles to failure. FTC foundation and footing contractor came out to establish the tolerance for the piles to be driven. West Bridge Contractor continues to excavate on the Eastside (Bent 3) for bridge construction. 5/04/21 Tuesday East Bridge @ Bent 3 contractor pouring footing for columns. West Bridge on East side of waterway continual excavation for bridge construction. 5/06/21 Thursday East Bridge & West Bridge has continued excavation and construction. 05/07/21 Friday West Bridge working @ Bent 3 constructing platform and forms to pour Cap. Contractor continues to grade for construction of bridge. Bridge crew constructing temporary water crossing at the West Bridge. 05/11/21 Tuesday West Bridge & East Bridge continued construction. 05/12/21 Wednesday East Bridge contractor poured the columns. @ Bent 1 - around 1:45PM contractor began driving piles for columns two were completed out of the seven total. (Piles were over 60 foot in length). West Bridge contractor still working on platform to install Cap @ Bent 3. 05/13/21 Thursday East Bridge contractor drove the remaining piles in @ Bent 1 & Bent 2 removed steel forms on columns. West Bridge contractor poured Cap @ Bent 2. 5/18/21 Tuesday East Bridge contractor working on framing to construction of Abutment 5/17/21. Started installation of steel wiring. West Bridge contractor removed framing off of Bent 2 for the Cap that was poured last week. Also contract began to install temporary bridge crossing. Condition @ site have been muddy due to the continuing rains over the past days. Possible rain for the rest of the week highs are projected at 70 degrees. 5/21/21 Friday West Bridge contractor clean up and move equipment. Contractor may driving piles for Abutment o Monday 5/24/21. East Bridge contractor continued framing & constructing steel wiring for Abutment. General construction of work site focused on the bridges. 5/24/21 Monday East Bridge contractor continued framing & construction. West Bridge contractor prepares for driving piles for Abutment. 5/25/21 Tuesday West Bridge contractor drove piles into for Abutment, piles where unable to be driven to failure. Contractor had to add extra footage on to piles so they can be driven to the proper depth. Olsson the Third party inspection that is overseeing the pile driving portion has a Wielding Inspector coming to site to inspect the pile wieldings . See pic of addition length of piles to be add. ( Bridge Crew operator hit a light pole on View High Dr near the front access entrance off of. I-470 Hwy.) East Bridge Still forming for pour on bridge @ Abutment & Bent 3. 5/26/21 Wednesday East Bridge Contractor poured Cap for Bent 3 the pouring of Abutment should start after lunch. West Bridge Contractor waiting for approval for wields on all piles those that have been Partial driven and those that have not been started. Olsson is the Third party inspection. 6/1/21 Tuesday East Bridge contractor pulled forms off of Bent 3 general work on bridge construction. West Bridge Contractor began to wield extensions on to the piles for abutment Olsson will Inspect wields possibly by tomorrow. General work construction continues. 6/2/21 Wednesday East Bridge contractor poured concrete for abutment and construction work on Bent 3. 6/3/21Thursday West Bridge contractor drove piles on the abutment. Contractor continued to general construction of West & East Bridge. 6/4/21 Friday West & East Bridge General Construction work. East Bridge building forms for Cap at Bent 2. 6/7/21 Monday East Bridge contractor constructing rebar for Cap on Bent 2 forms were removed from Abutment. West Bridge General Construction work. 6/8/21 Tuesday West Bridge contractor began driving piles for Bent 4. East Bridge contractor continued to construct rebar to form Cap on Bent 2. 6/9/21 Wednesday West Bridge contractor continued to build forms and construct rebar for Cap @ Bent 2 East Bridge contractor completed driving piles Third Party inspector was done by Olsson . The contractor is constructing forms and rebar for Abutment (Bent 1). 6/10/21 Thursday West Bridge general construction to began columns on Bent 4. East Bridge contractor (Clarkson Kurt Bridge crew) poured Cap on Bent 2. 6/11/21 Friday West Bridge Contractor continued to build forms and install rebar on Bent 1 or Abutment. East Bridge water truck working the soil for the Bent 4 installation. 6/15/21 Tuesday West Bridge Contractor continued to prepare Bent 1 for construction 6/14/21. Today: Contractor is pouring concrete for Bent 1 (Abutment). Olsson is perform testing on concrete mix. Construction continues on Bent 4. East Bridge Contractor began pulling form off Cap of Bent 2 on 6/14/21 continued working 6/15/21. Contractor continued to prepare soil along Eastside of waterway for Bent 4 installation. 6/16/21 Wednesday East Bridge Contractor continued complete pulled forms off the Cap of Bent 2. Working on stabilization for Bent 4. 6/17/21 Thursday West Bridge Contractor performing general construction to build bridge. East Bridge Contractor complete platform West-bank of waterway to enable equipment to access area to continue construction. 6/18/21 Friday West & East Bridge contractor brought in shot rock to stabilize slope of soil around bridge columns & base. Contractor continued to grade and perform general activity for construction of bridges. 6/21/21 Monday West & East Bridge contractor continues to bring in shot rock to stabilize slope around bridge. Contractor continue to perform general work on bridge. 6/22/21 Tuesday East Bridge @ Bent 4 contractor drove piles for columns. Contractor continues to grade area for construction of bridge. 6/23/21 Wednesday West & East Bridge @ Bent 4 contractor are working on forms rebar for structures. Continue to stabilize area around bridges. 6/25/21 Friday West & East Bridge contractor installed Support Beams & rebar. West & East Bridge contractor still working on Bent 4 of each bridge and soil foundation. 6/28/21 Monday West & East Bridge contractor was pouring Bents 4(abutments). General bridge construction continued condition of the grounds are muddy do to rainy weather. 7/6/21 Tuesday Continued construction on Bridges. 7/9/21 Friday Contractor has continued Bridge construction on the West East bridges. See pic from todays date . 7/12/21 Monday East Bridge contractor continued construction of bridge on expansion and Bent 4 (Abutment). The Bent 4 should be poured by tomorrow. 7/13/21 Tuesday East Bridge contractor continued construction of bridge, Bent 4 (Abutment) will began concrete pour about 8:30AM tomorrow. 7/14/21 Wednesday East Bridge contractor is pouring Bent 4 (Abutment) and continuing construction on bridge. 7/15/21 Thursday Contractor were working on West & East Bridge but had to stop due to inclement weather conditions (rains). This caused all projects to prematurely stop for the day ( water, street, electrical, soil testing, grading & bridge construction.) 7/16/21 Friday Contractor continued construction of East Bridge. 7/19/21 Monday Contractor continued construction on West and East Bridges. 7/20/21 Tuesday Contractor continued construction of West Bridge. East Bridge contractor removed frames for Bent 4 (abutment). 7/21/21 Wednesday Contractor continued construction of West Bridge. East Bridge contractor staged rip-rap for bridge under-path. 7/22/21 Thursday Contractor continued construction of West Bridge. East Bridge started rip-rap for bridge under-path. 7/23/21 Friday Frames and forms were continual constructed on the West Bridge. Rebar was delivered for the East Bridge to continue bridge construction. 7/26/21 Monday continued framing and construction on West Bridge. 7/27/21 Tuesday continued framing & construction of West Bridge. 7/28/21 Wednesday Contractor continued framing & construction of West Bridge. Contractor was installing rip-rap and construction on East Bridge. 7/29/21 Thursday Contractor continued construction of West Bridge. 7/30/21 Friday Contractor continued construction of West Bridge. 8/2/21 Monday Contractor continued the construction of and framing of West Bridge. 8/4/21 Wednesday Contractor working on construction of West & East Bridge. 8/10/21 Tuesday Contractor working on construction of West & East Bridge. 8/11/21 Wednesday Contractor continued work on Bridges. 8/13/21 Friday Rebar was delivered to the site yesterday. Construction work continues on West & East Bridges. 8/16/21 Monday Work continues on bridges, box forms have been stage at West Bridge. 8/17/21 Tuesday Contractor continued to construction on West Bridge. East Bridge long epoxy green coated rebar was delivered. 8/19/21 Thursday Contractor continues to construction on bridges. 8/20/21 Friday Bridge crews continued construction on West & East Bridge. Contractor began framing of roadway across East Bridge. 8/24/21 Tuesday Bridge crews worked on West & East Bridge. 8/26/21 Thursday Contractor continued working on bridges construction on East & West site. 9/1/21 Wednesday Contractor continued work on the East & West bridges. 9/2/21 Thursday Contractor continues with rebar construction on East & West bridges. Erosion control appears to be satisfactory around and waterway. 9/7/21 Tuesday Contractor continues with rebar construction on West bridge tomorrow they will began to pour pavement for bridge at 3:00AM. 9/9/21 Thursday Contractor poured pavement surface on West bridge of on 9/8/21 when I was @ jury duty. Contractor began framing on West bridge to continue construction. East bridge being framed for pouring of pavement . 9/14/21 Tuesday Contractor continued construction frames to and rebar to pour surface pavement for East bridge. 9/16/21 Thursday Contractor continued construction and framing & rebar for East bridge. 9/20/21 Monday Contractor continued construction on East bridge. 9/21/21 Tuesday Contractor continued construction on West & East bridge. Clarkson Darron crew will work on the excavation of the abutment on (Eastside) of the West bridge. 9/23/21 Thursday Contractor has removed curing blankets from West bridge and continues frame and rebar walkways of bridge. Additional rip-rap was add to the under-path and beneath bridge for soil erosion control as-per plan. Clarkson Darron crew will work on the excavation of the abutment on (Westside) of the West bridge. Contractor is also work on the rebar of decking on the East bridge, and possibly being ready to pour bridge deck by next Friday. 9/24/21 Friday Contractor continued construction of the East bridge to pour the deck of bridge. 9/27/21 Monday Contractor continued construction of East bridge. 9/28/21 Tuesday Contractor continued construction on East bridge. 9/29/21 Wednesday Contractor continued Const on West & East Bridges. 9/30/21 Thursday Contractor poured a portion of the street & bridge a section approach for West bridge on View High Drive. See photos for the day. East bridge construction continues. 10/01/21 Friday Contractor continues to work West & East bridge. 10/04/21 Monday Contractor continues to work West & East bridge. 10/05/21 Tuesday Contractor continued to prepare East bridge for surface pour. Contractor will pour approximately 390 yards of concrete for bridge @ 2:00 am 10/06/21 Wednesday. I have informed my supervisor about the time and date of pour (Third party testing should be onsite Olsson). West bridge continue with the construction of abutment on View High Drive. 10/14/21 Thursday East bridge continued to cure. The contractor continued construction on West and East bridge. 10/18/21 Monday Contractor poured bridge walls on the West bridge. East bridge contractor began pulling forms. 10/19/21 Tuesday Contractor continued to work on West bridge. 10/20/21 Wednesday Contractor continued to pour concrete on West bridge for barricades walls. East bridge contractor framing abutment on the Westside. 10/21/21 Thursday Contractor remove West bridge frames from West bridge barricade walls. Contractor removed curing cloth from East bridge. 11/05/21 Friday Contractor has been installing rebar for bridge barricade wall between walking and road. 11/15/21 Monday (Clarkson Bridge crew) Have been working progress on framing & rebar for East bridge barricade for pedestrians sidewalks. 11/22/21 Monday Contractor poured a portion of the East bridge for wall barricade. Contractor continued construction on East bridge. 12/01/21 Wednesday Clarkson bridge crew continued to work West & East bridge. The road that will connect the bridges subgrade is being raised and stabilize with shot rock before the clay for road is installed. The contractor has removed metal corrugated pipe that was used to maintain a steady water flow in the rivers under bridge. 12/02/21 Thursday Contractor is pouring the transitional part of the concrete barricade on the West & East bridge approaches. Contractor continued grading around & under bridge area as per project plans. 12/06/21 Monday Contractor continued to work on the West & East bridge. Installing conduit on the East bridge. 03/18/22 Friday Approaches for the West & East Bridges have not been poured and the fencing for the bridges have not been installed. 04/19/22 Tuesday Contractor has completed the installation of railing for the West bridge off of View High Drive and near completion of decorative railing on East bridge off of River Road.
Retaining Wall Inspection Partial 06/17/2021
Misc
Informational
06/07/2021

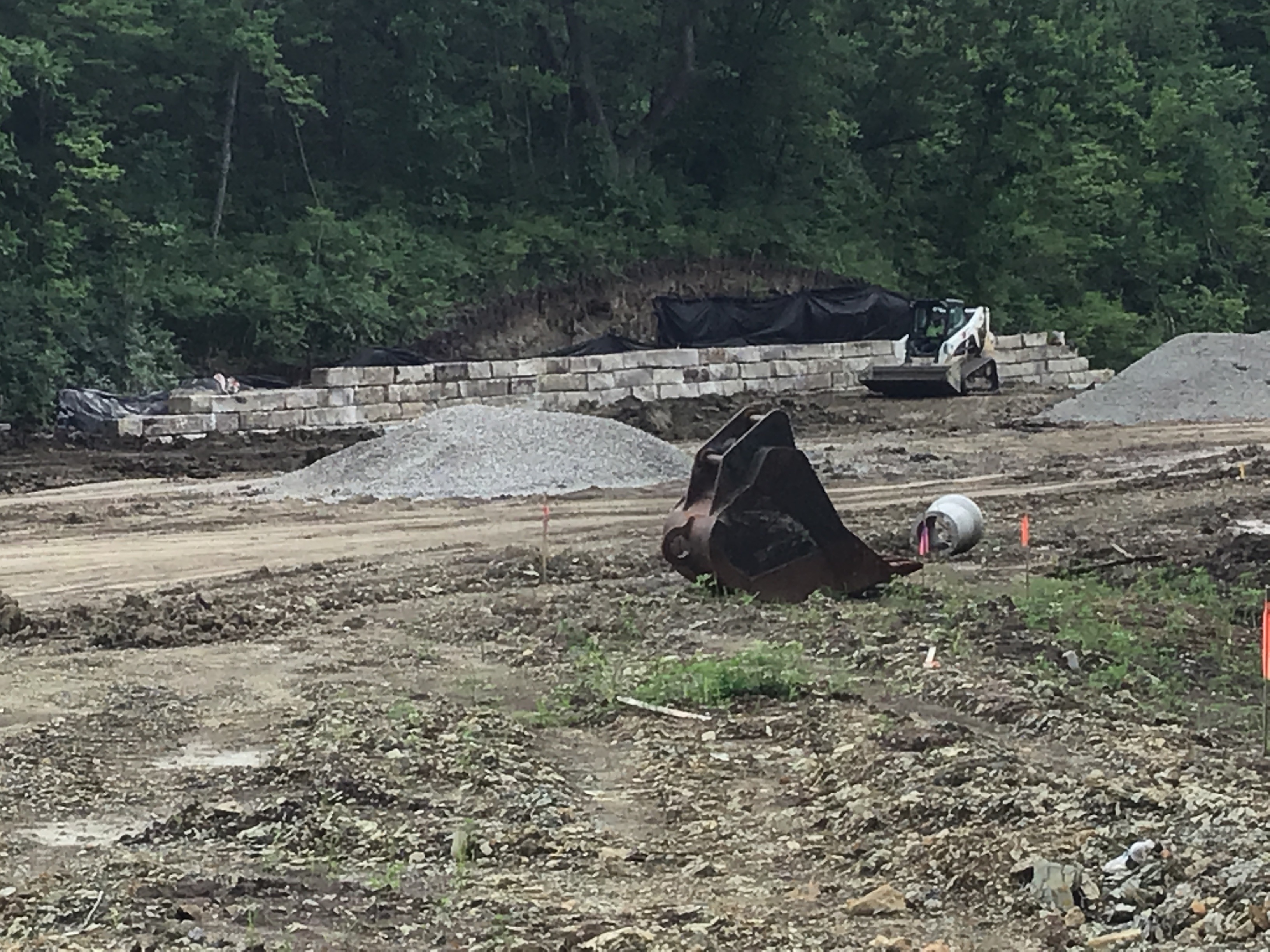

6/17/21 Thursday BC Hardscapes Landscape Construction is building the Rataining wall that is located @ the Northside of View High Parkway. Olsson is doing the inspection and sending the result to the city of Lee’s Summit. Work has been going for approximately 1 month.
Sanitary Sewer Construction Inspection Partial 06/23/2021
Misc
Informational
06/23/2021
Contractor (Clarkson- Darron crew) perform raised existing manhole to future grade. Contractor backfilled excavation around manhole. Manhole is located on the Southeast side of View High Trafficway & View High Parkway.
Storm Sewer Construction Inspection Partial 12/15/2022
Misc
Informational
12/15/2022

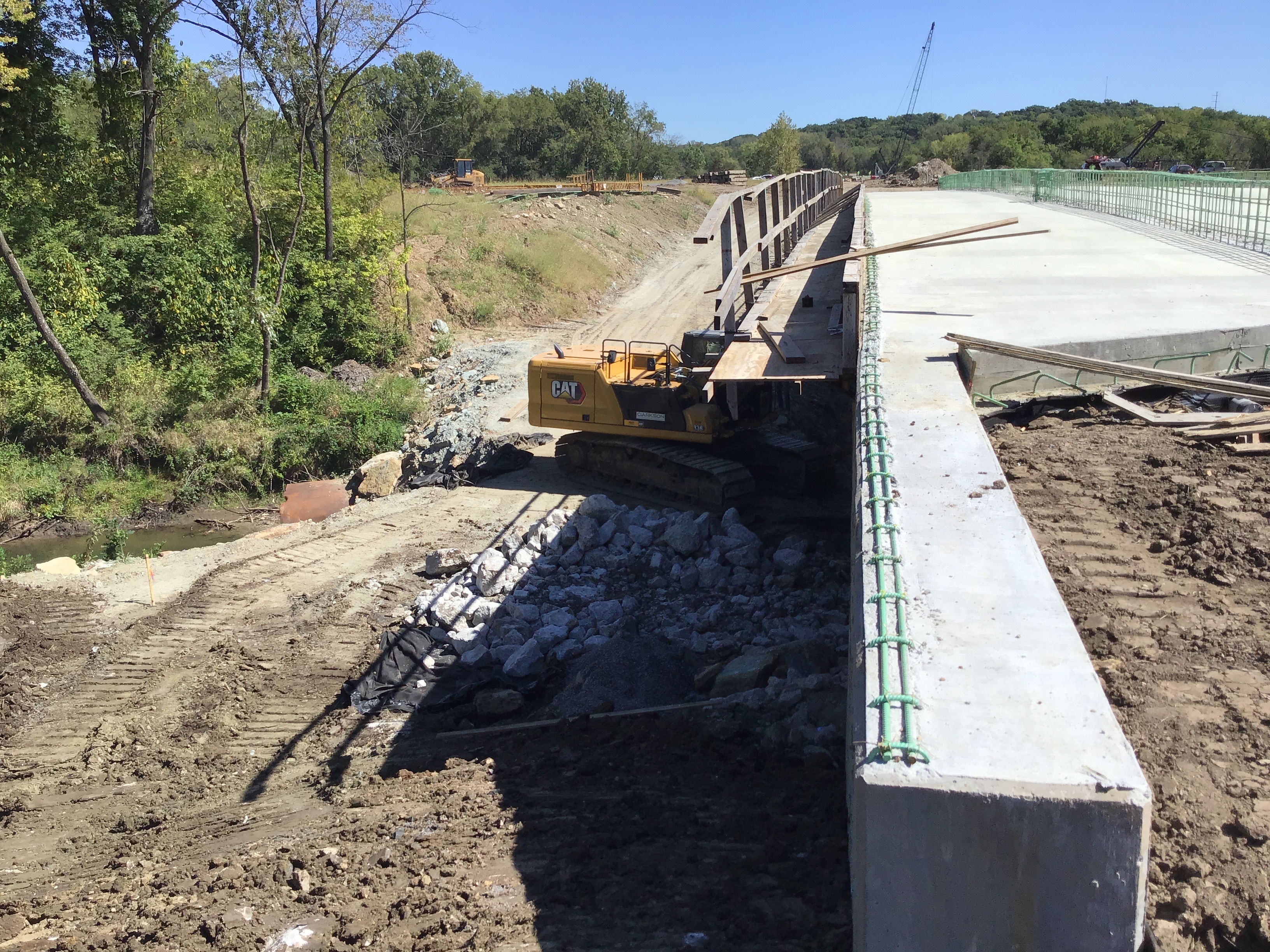

12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East.
Storm Sewer Construction Inspection Partial 12/16/2022
Misc
Informational
12/15/2022
12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East. 12/16/22 Friday JMJ ( Pro Design ) Contractor installed base for storm box 2101 yesterday and approximately 125’ of 36” HDPE corrugated pipe to base of storm box 2102 ( yesterday & today ). Contractor plans to continue on and install approximately 60’ of 30” HDPE corrugated pipe to and install base of storm box 2103. Contractor has ordered concrete for collars for 2 PM today for storm boxes and partially back excavation.
Storm Sewer Construction Inspection Partial 12/16/2022
Misc
Informational
12/16/2022
12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East. 12/16/22 Friday JMJ ( Pro Design ) Contractor installed base for storm box 2101 yesterday and approximately 125’ of 36” HDPE corrugated pipe to base of storm box 2102 ( yesterday & today ). Contractor plans to continue on and install approximately 60’ of 30” HDPE corrugated pipe to and install base of storm box 2103. Contractor has ordered concrete for collars for 2 PM today for storm boxes and partially back excavation. Contractor was unable to install storm box 2103 due to the obstacles of other service lines and junction boxes. Contractor did pour the invert for 2102.
Storm Sewer Construction Inspection Partial 12/19/2022
Misc
Informational
12/16/2022
12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East. 12/16/22 Friday JMJ ( Pro Design ) Contractor installed base for storm box 2101 yesterday and approximately 125’ of 36” HDPE corrugated pipe to base of storm box 2102 ( yesterday & today ). Contractor plans to continue on and install approximately 60’ of 30” HDPE corrugated pipe to and install base of storm box 2103. Contractor has ordered concrete for collars for 2 PM today for storm boxes and partially back excavation. Contractor was unable to install storm box 2103 due to the obstacles of other service lines and junction boxes. Contractor did pour the invert for 2102. 12/19/22 Monday JMJ ( Pro Design ) Contractor was able to go under encase sanitary line and continue installing 30” HDPE corrugated pipe to storm box 2103.
Storm Sewer Construction Inspection Partial 12/20/2022
Misc
Informational
12/19/2022
12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East. 12/16/22 Friday JMJ ( Pro Design ) Contractor installed base for storm box 2101 yesterday and approximately 125’ of 36” HDPE corrugated pipe to base of storm box 2102 ( yesterday & today ). Contractor plans to continue on and install approximately 60’ of 30” HDPE corrugated pipe to and install base of storm box 2103. Contractor has ordered concrete for collars for 2 PM today for storm boxes and partially back excavation. Contractor was unable to install storm box 2103 due to the obstacles of other service lines and junction boxes. Contractor did pour the invert for 2102. 12/19/22 Monday JMJ ( Pro Design ) Contractor was able to go under encase sanitary line and continue installing 30” HDPE corrugated pipe to storm box 2103. 12/20/22 Tuesday JMJ ( Pro Design ) Contractor continued installation of 30” HDPE corrugated pipe and storm box 2104, approximately 140’ of storm pipe was laid today. Contractor poured the inverts and collars for storm box 2103 & 2104.
Storm Sewer Construction Inspection Partial 12/21/2022
Misc
Informational
12/20/2022
12/15/22 Thursday JMJ ( Pro Design ) Contractor began working on the storm Southeast of the fields on Monday 12/12/22. Construction of storm line began at the outlet. Approximately 160’ of 42” RCP, was installed. Contractor plans to install 36” HDPE corrugated pipe that connected directed towards the East. 12/16/22 Friday JMJ ( Pro Design ) Contractor installed base for storm box 2101 yesterday and approximately 125’ of 36” HDPE corrugated pipe to base of storm box 2102 ( yesterday & today ). Contractor plans to continue on and install approximately 60’ of 30” HDPE corrugated pipe to and install base of storm box 2103. Contractor has ordered concrete for collars for 2 PM today for storm boxes and partially back excavation. Contractor was unable to install storm box 2103 due to the obstacles of other service lines and junction boxes. Contractor did pour the invert for 2102. 12/19/22 Monday JMJ ( Pro Design ) Contractor was able to go under encase sanitary line and continue installing 30” HDPE corrugated pipe to storm box 2103. 12/20/22 Tuesday JMJ ( Pro Design ) Contractor continued installation of 30” HDPE corrugated pipe and storm box 2104, approximately 140’ of storm pipe was laid today. Contractor poured the inverts and collars for storm box 2103 & 2104. 12/21/22 Wednesday JMJ ( Pro Design ) Contractor installed approximately 20’ of 24” HDPE corrugated storm pipe yesterday between storm box 2103 to 2104. Approximately 180’ of 18” HDPE corrugated storm pipe was and 2105 & 2106. Contractor plans for concrete @ 2:00 PM today to pour invert and collar.
Documents & Images
Date Uploaded File Type Document Name
09/24/2020 Receipt Receipt for transaction:2020-006446
09/24/2020 Approved Plans Paragon Star - Village Private Water Line Approved 9.24.20
09/24/2020 Letter DE-Permit
03/04/2021 Receipt Receipt for transaction: 2021-001082
03/04/2021 Letter INSPECTION SUMMARY
03/04/2021 Letter INSPECTION SUMMARY
03/05/2021 Approved Plans Paragon Star East Bridge Approved 3.5.21
03/05/2021 Approved Plans Paragon Star West Bridge Approved 3.5.21

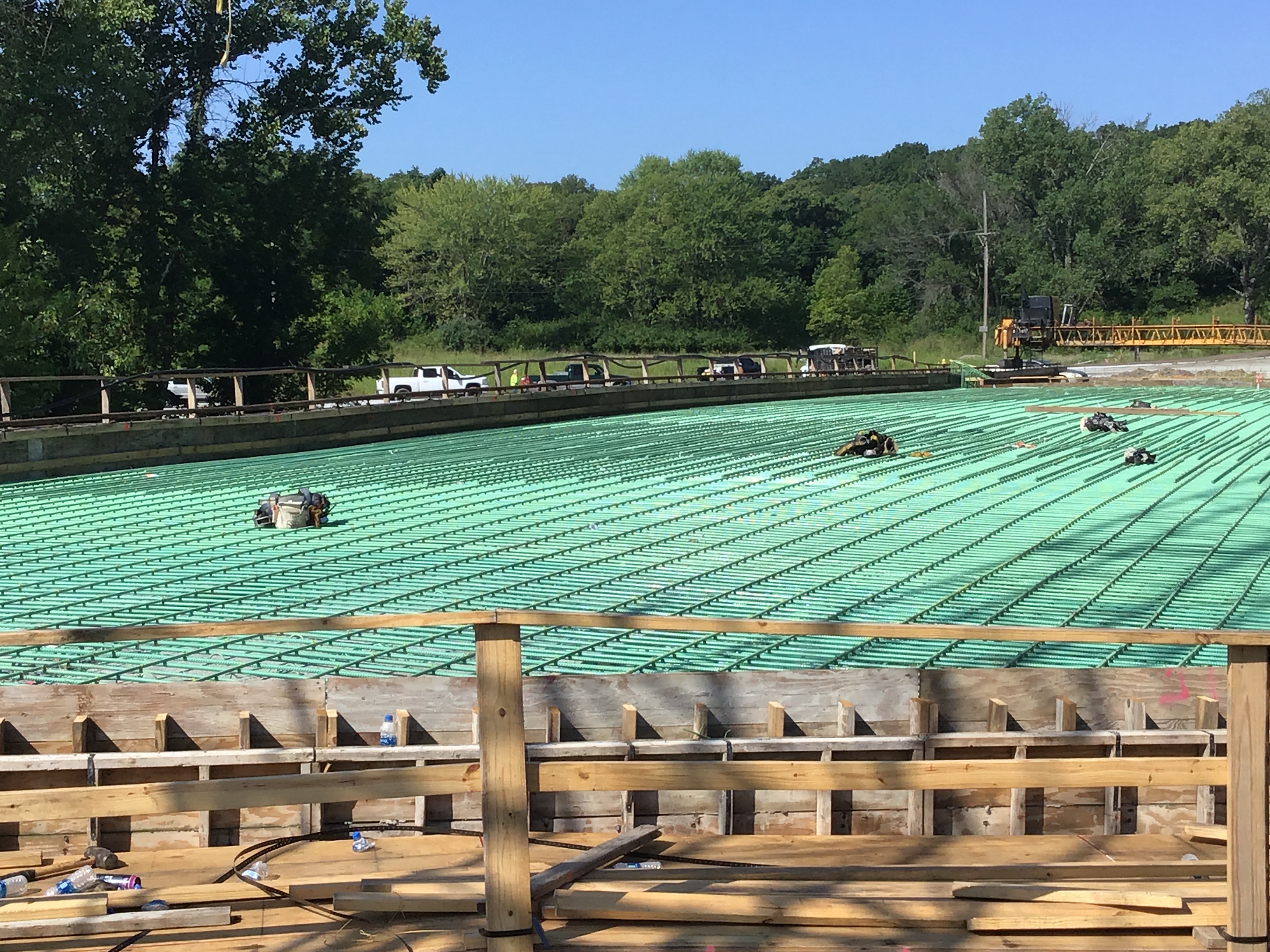

03/09/2021 image.jpg
03/09/2021 Letter INSPECTION SUMMARY

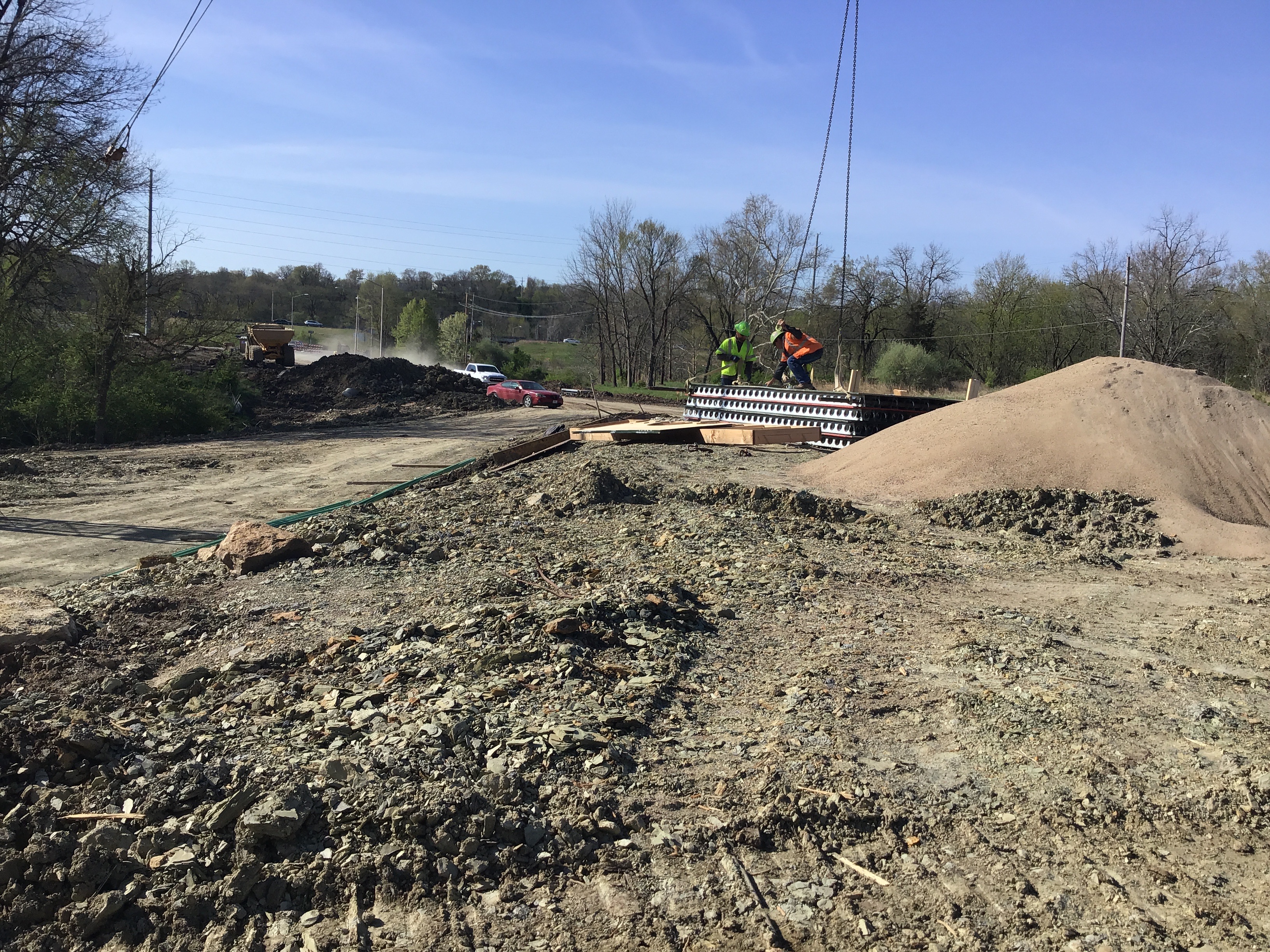

03/09/2021 Photograph image.jpg0
03/09/2021 Photograph image.jpg1

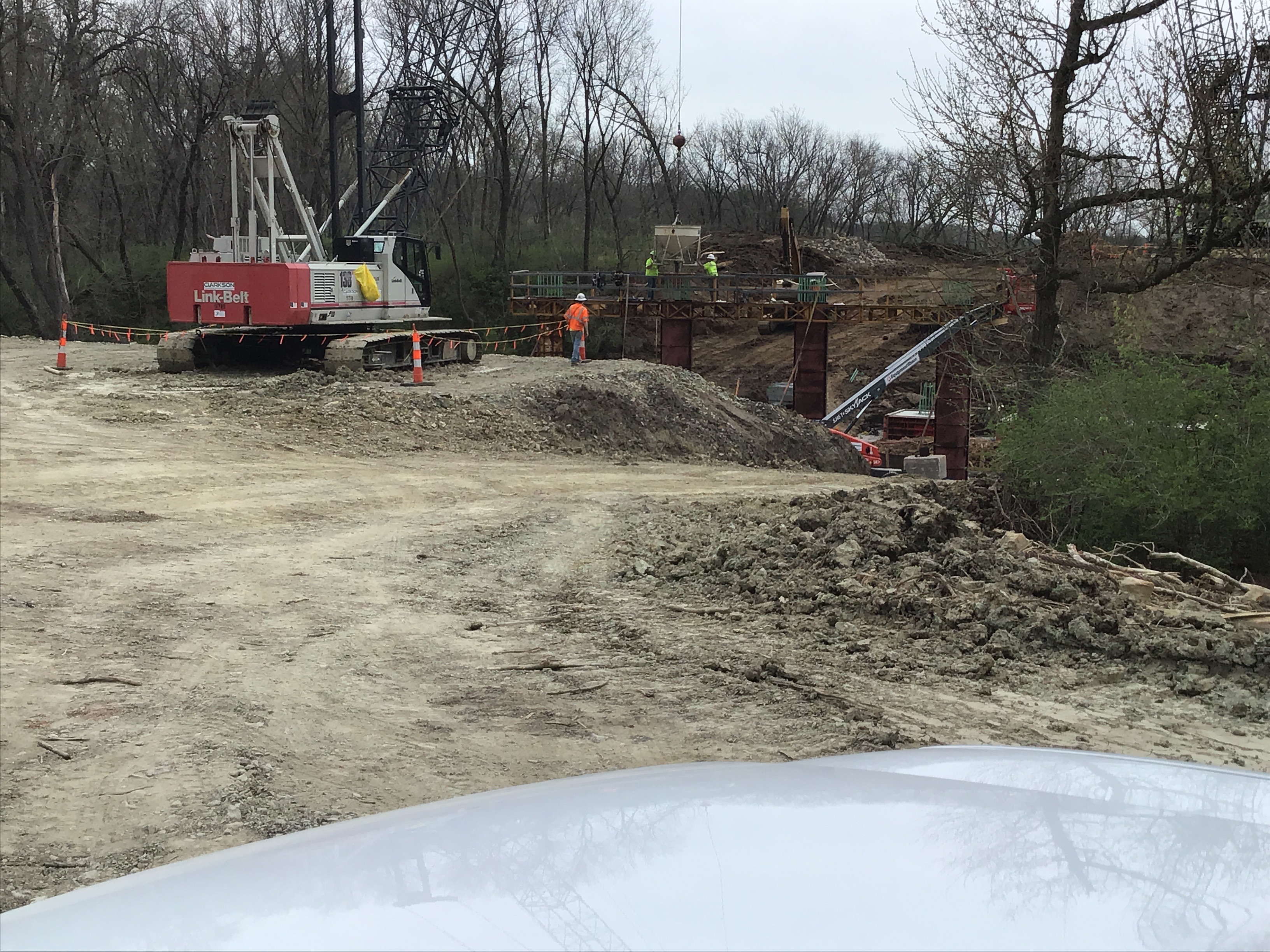

03/09/2021 Photograph image.jpg2
03/09/2021 Letter INSPECTION SUMMARY
03/10/2021 Letter INSPECTION SUMMARY
03/10/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/11/2021 Letter INSPECTION SUMMARY
03/12/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY
03/16/2021 Letter INSPECTION SUMMARY

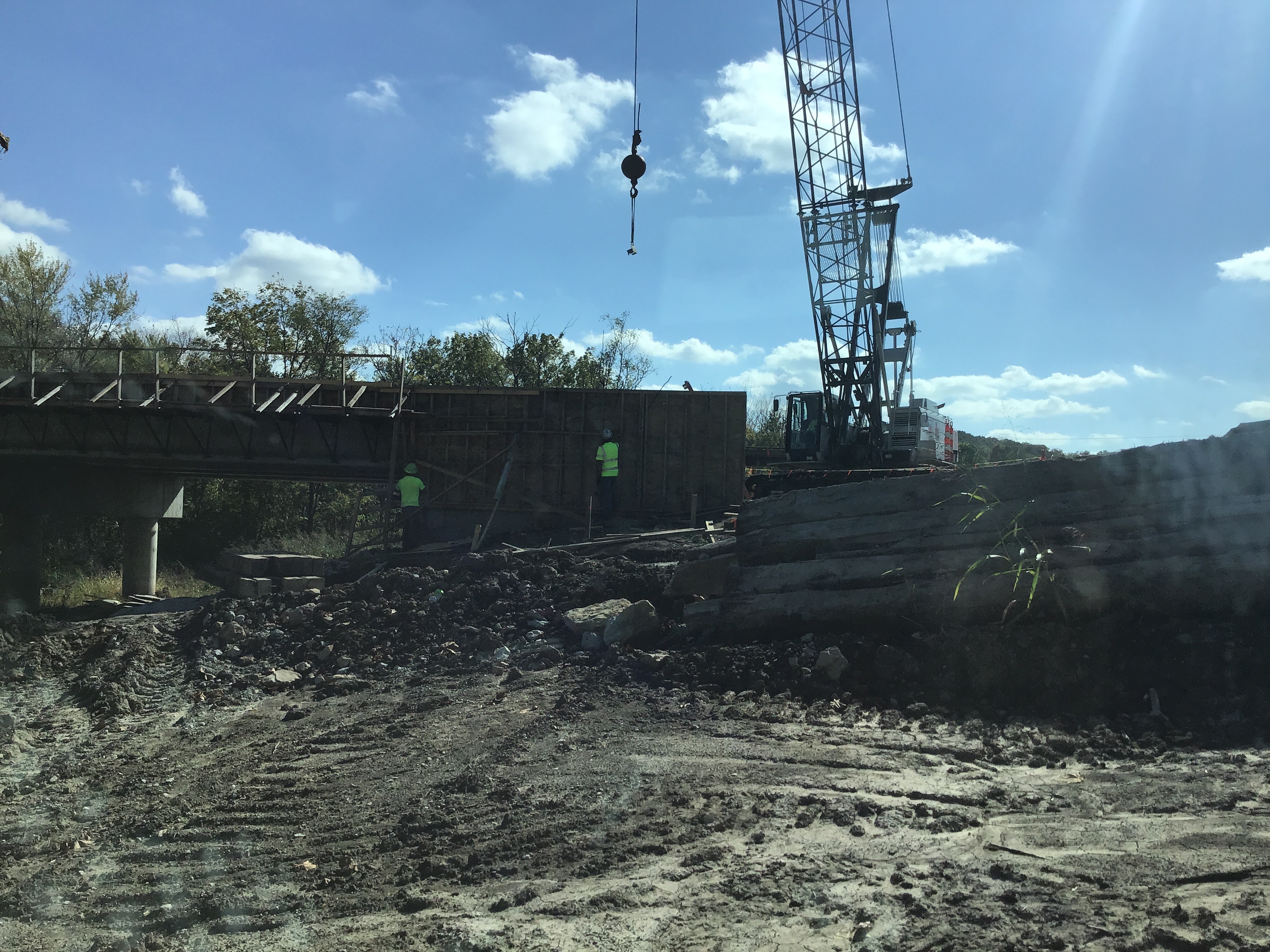

03/22/2021 image.jpg3
03/22/2021 image.jpg4
03/22/2021 image.jpg5
03/22/2021 image.jpg6
03/22/2021 Letter INSPECTION SUMMARY
03/23/2021 Letter INSPECTION SUMMARY
03/23/2021 Letter INSPECTION SUMMARY
03/26/2021 Letter INSPECTION SUMMARY
03/30/2021 Letter INSPECTION SUMMARY
03/31/2021 Letter INSPECTION SUMMARY

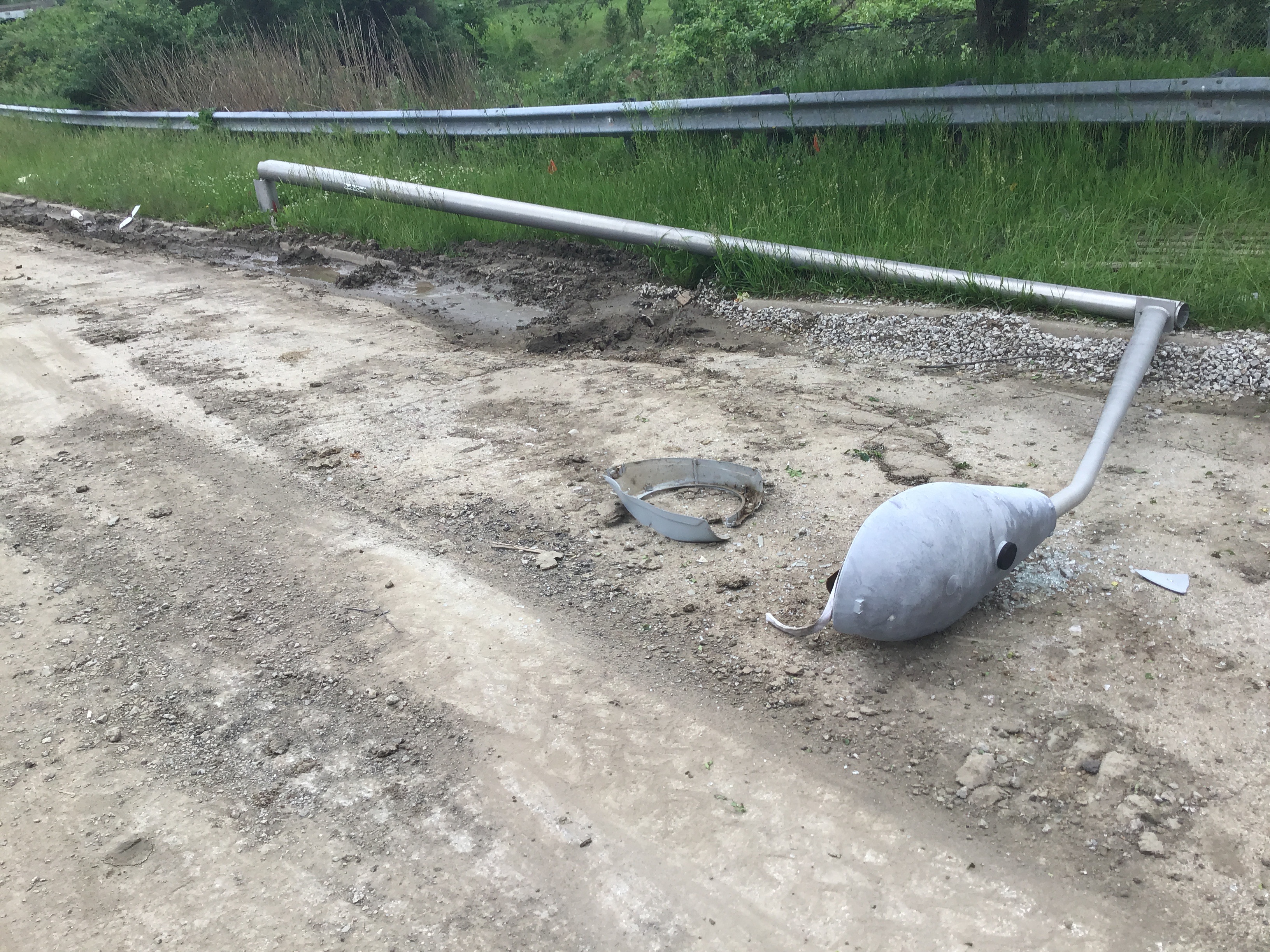

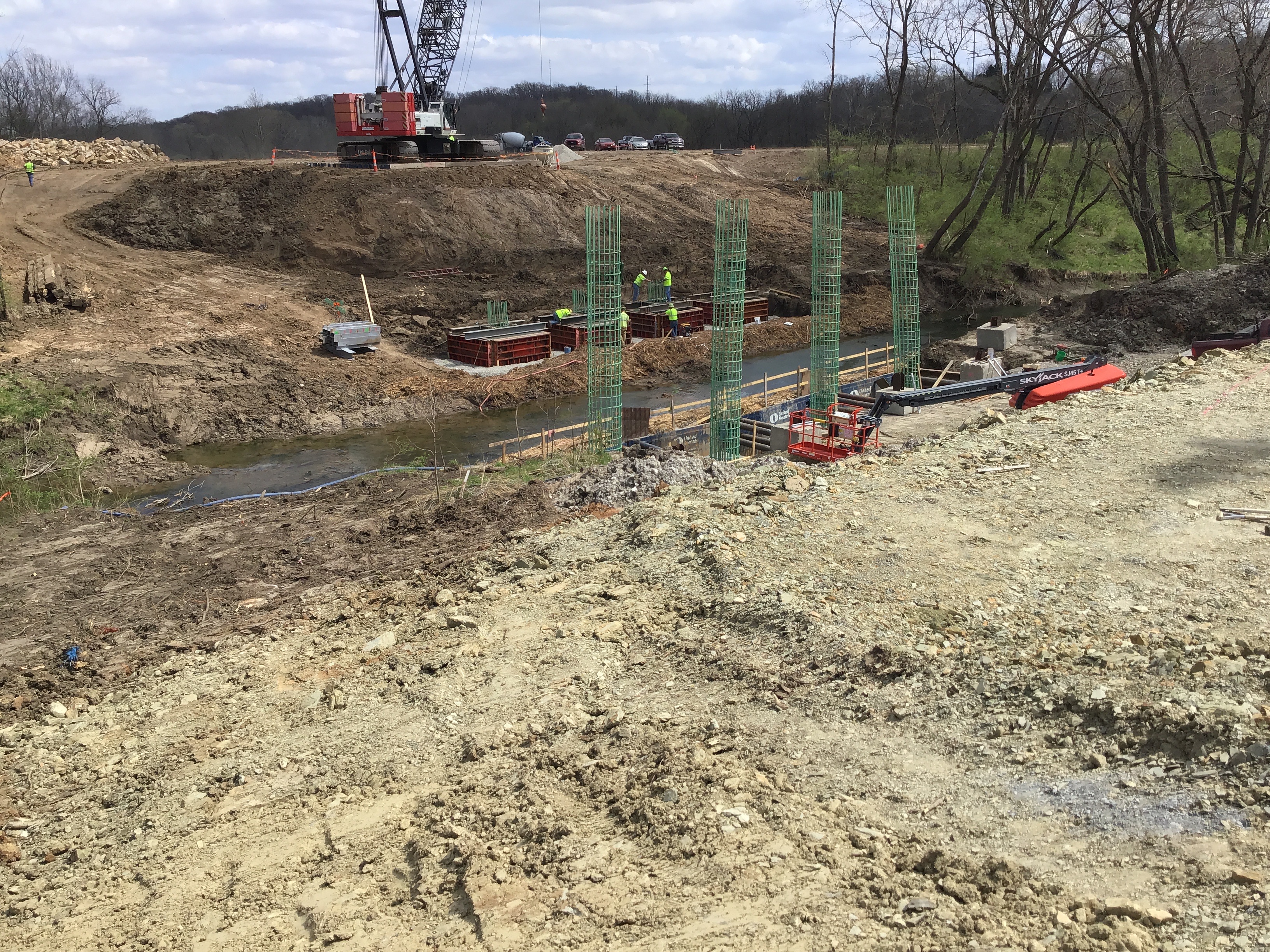

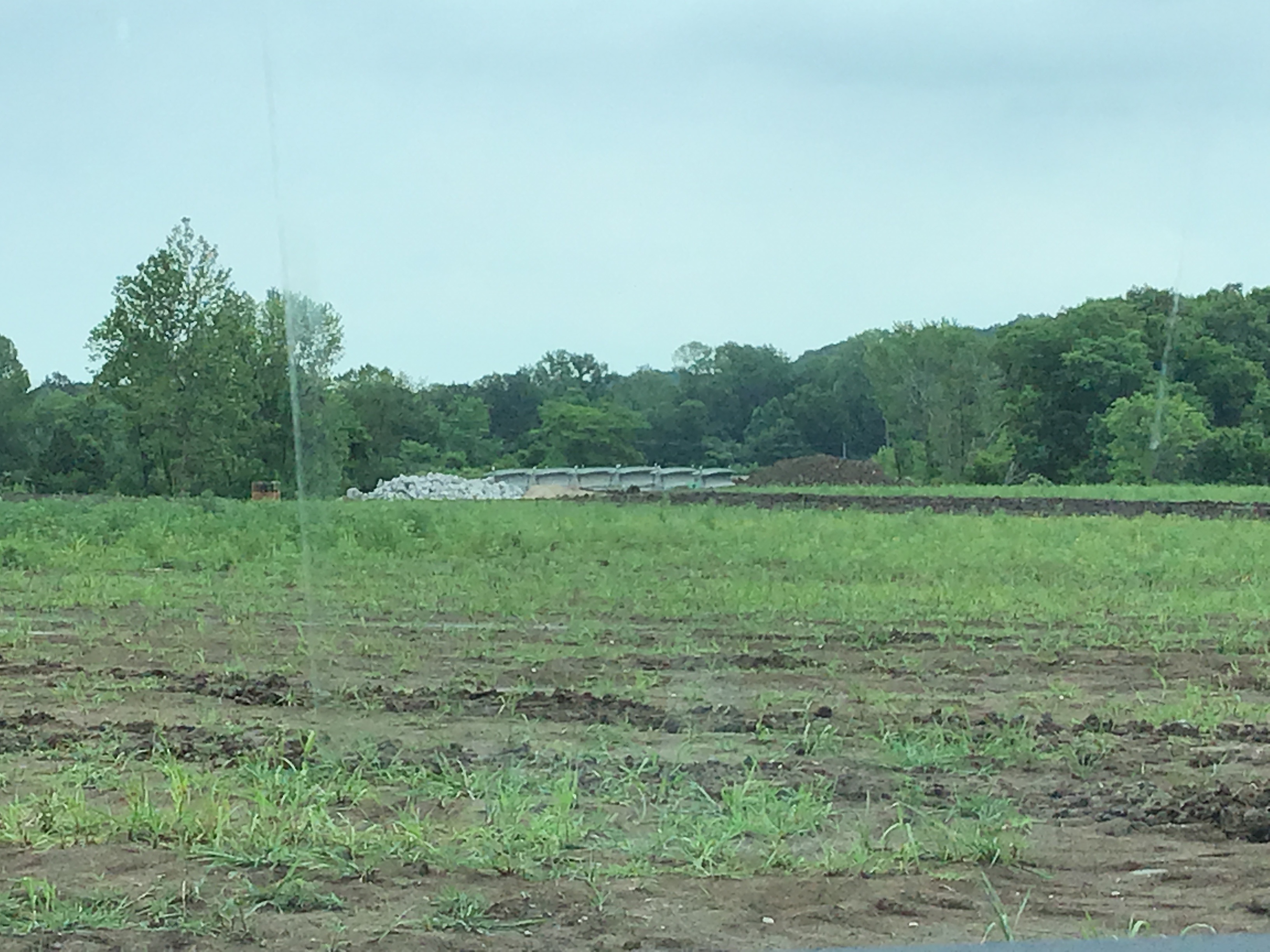

03/31/2021 image.jpg7
03/31/2021 Letter INSPECTION SUMMARY

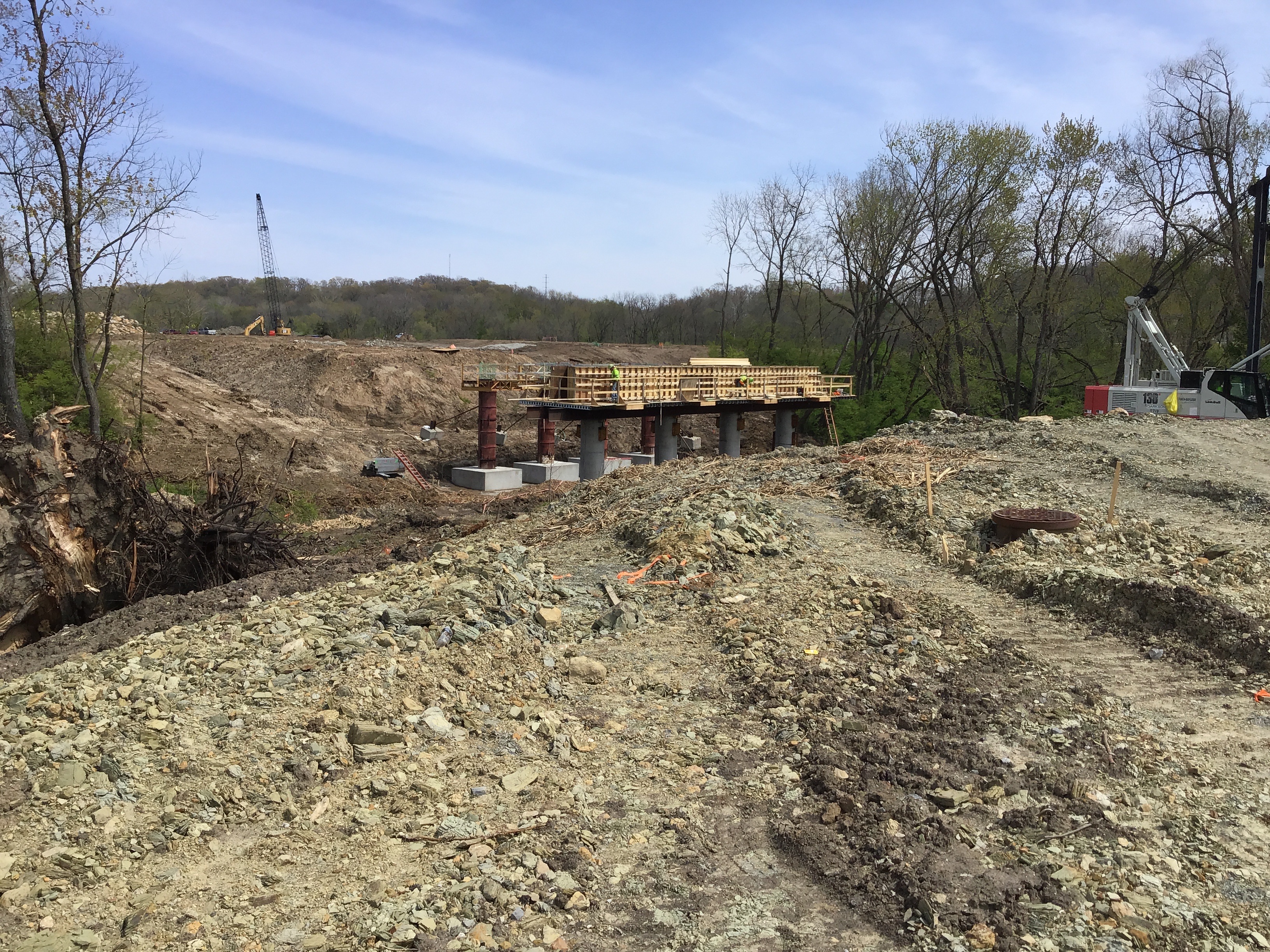

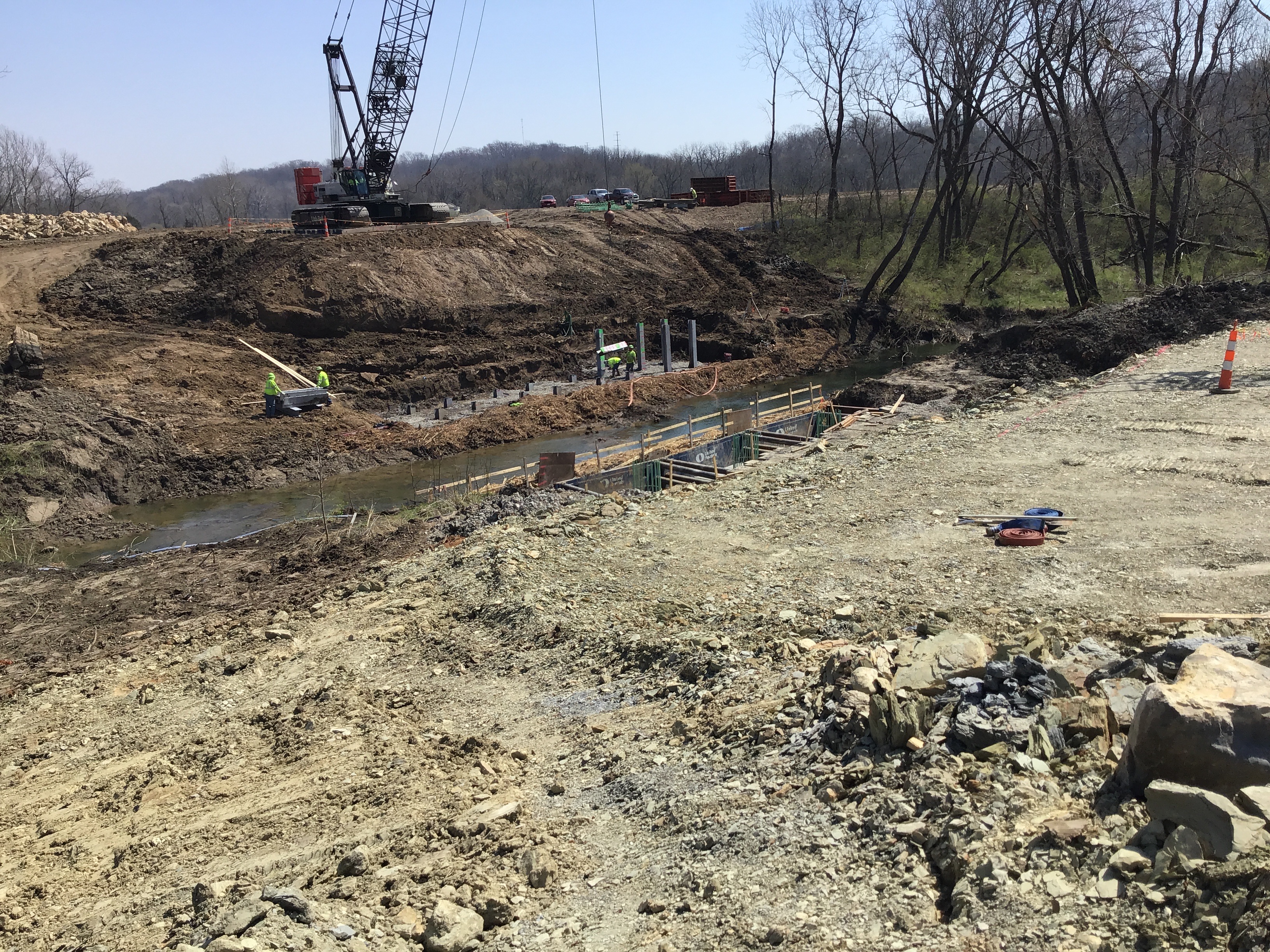

04/01/2021 image.jpg8
04/01/2021 image.jpg9
04/01/2021 Letter INSPECTION SUMMARY
04/01/2021 Letter INSPECTION SUMMARY
04/01/2021 image.jpg10
04/01/2021 Letter INSPECTION SUMMARY
04/02/2021 image.jpg11
04/02/2021 Letter INSPECTION SUMMARY
04/02/2021 Letter INSPECTION SUMMARY
04/02/2021 image.jpg12

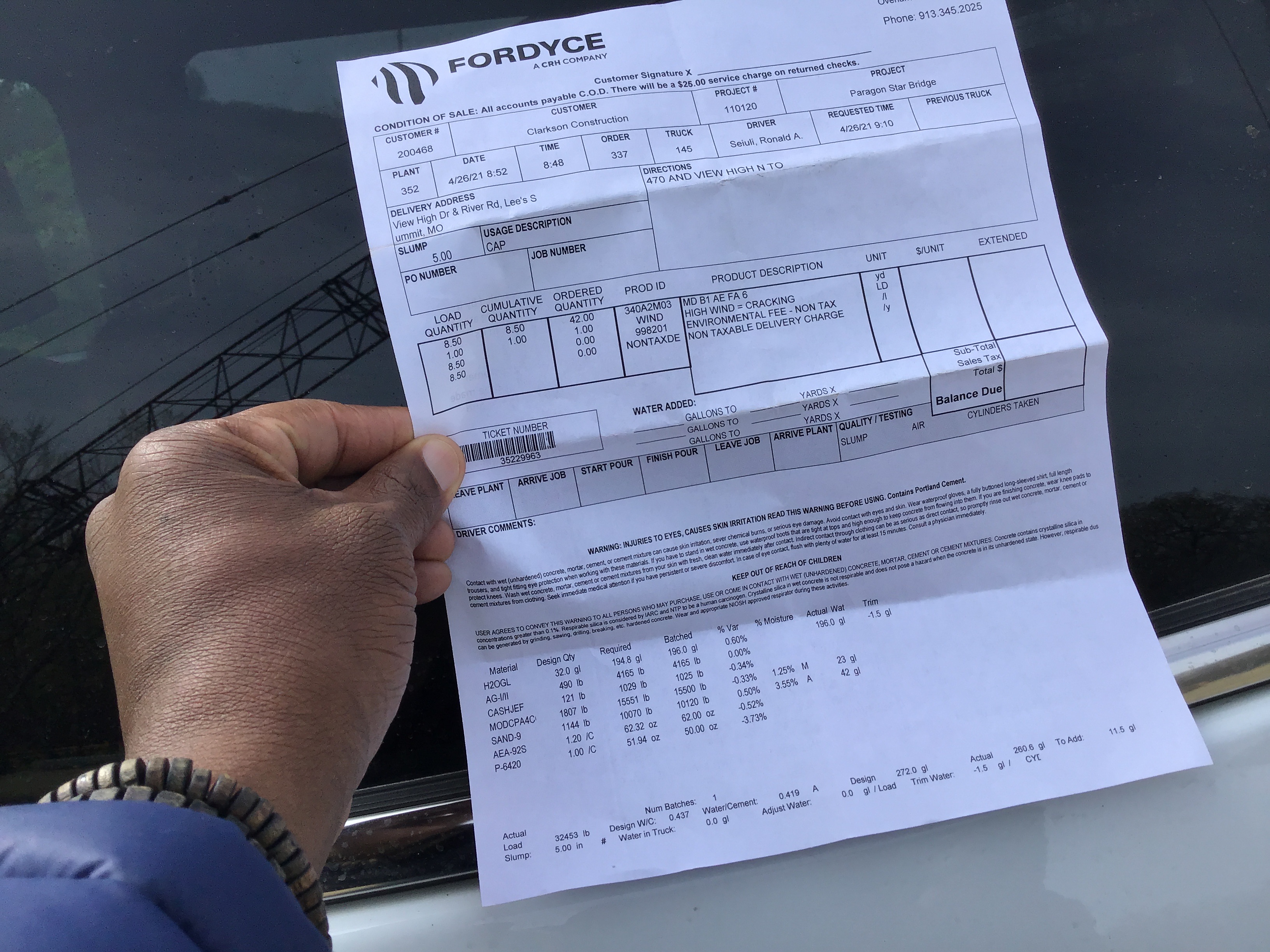

04/05/2021 image.jpg13
04/05/2021 Letter INSPECTION SUMMARY
04/05/2021 image.jpg14
04/05/2021 image.jpg15
04/05/2021 Letter INSPECTION SUMMARY
04/05/2021 image.jpg16
04/06/2021 image.jpg17
04/06/2021 Letter INSPECTION SUMMARY
04/12/2021 image.jpg18
04/12/2021 Letter INSPECTION SUMMARY
04/13/2021 image.jpg19
04/13/2021 Letter INSPECTION SUMMARY
04/13/2021 Letter INSPECTION SUMMARY
04/14/2021 image.jpg20
04/14/2021 image.jpg21
04/14/2021 Letter INSPECTION SUMMARY
04/14/2021 image.jpg22
04/14/2021 Letter INSPECTION SUMMARY
04/14/2021 Letter INSPECTION SUMMARY
04/15/2021 image.jpg23
04/15/2021 image.jpg24
04/15/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/15/2021 Letter INSPECTION SUMMARY
04/19/2021 image.jpg25
04/19/2021 Letter INSPECTION SUMMARY
04/21/2021 Letter INSPECTION SUMMARY
04/21/2021 Letter INSPECTION SUMMARY
04/22/2021 Letter INSPECTION SUMMARY
04/22/2021 image.jpg26
04/22/2021 image.jpg27
04/22/2021 Letter INSPECTION SUMMARY
04/23/2021 image.jpg28
04/23/2021 image.jpg29
04/23/2021 Letter INSPECTION SUMMARY

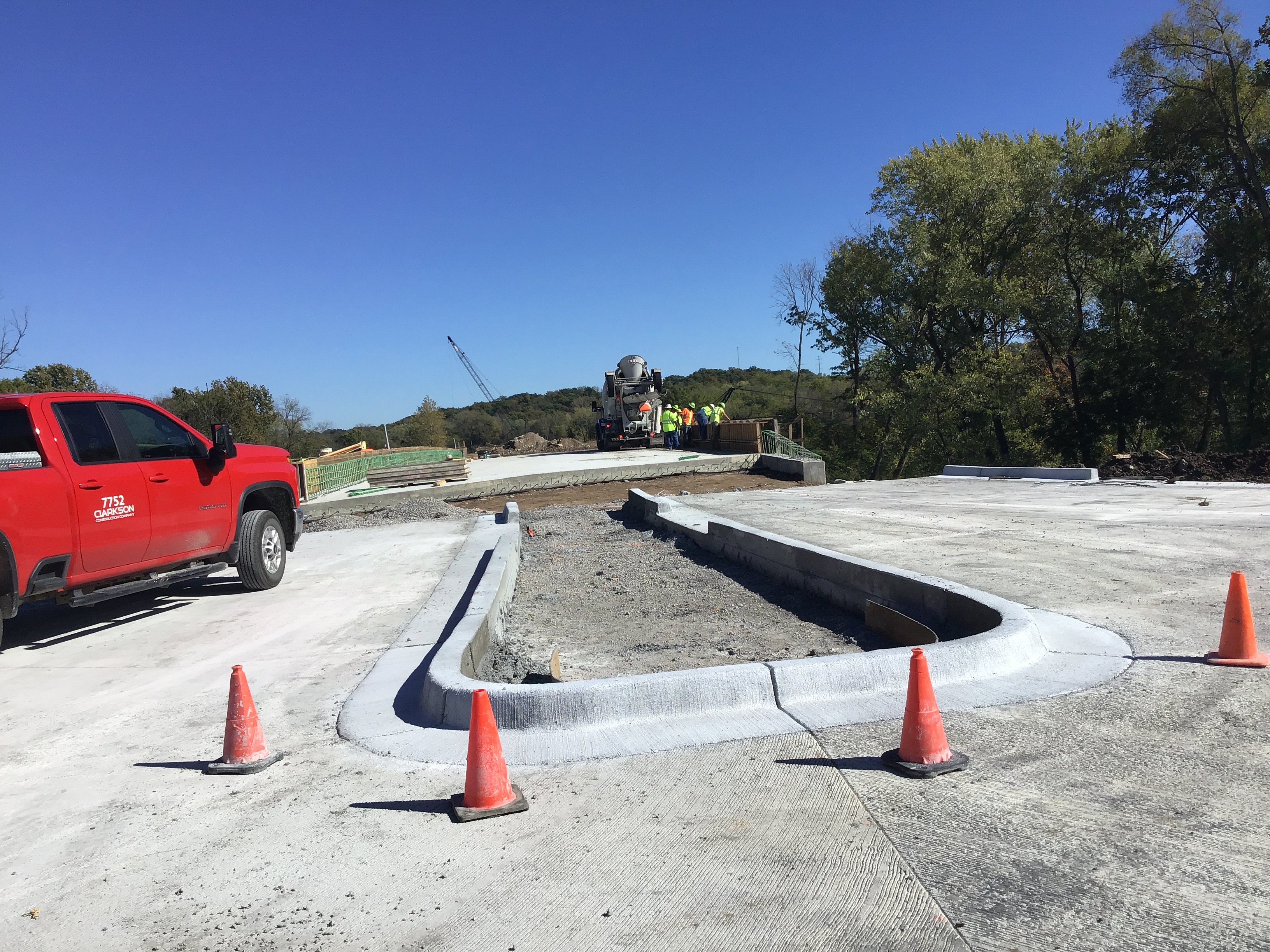

04/26/2021 image.jpg30
04/26/2021 64114144044__9821F184-EE79-43E5-9AD1-4E8E612F5D26.MOV
04/26/2021 image.jpg31
04/26/2021 image.jpg32
04/26/2021 Letter INSPECTION SUMMARY
04/27/2021 Letter INSPECTION SUMMARY
04/27/2021 Letter INSPECTION SUMMARY
04/28/2021 image.jpg33
04/28/2021 image.jpg34
04/28/2021 Letter INSPECTION SUMMARY
04/29/2021 Letter INSPECTION SUMMARY

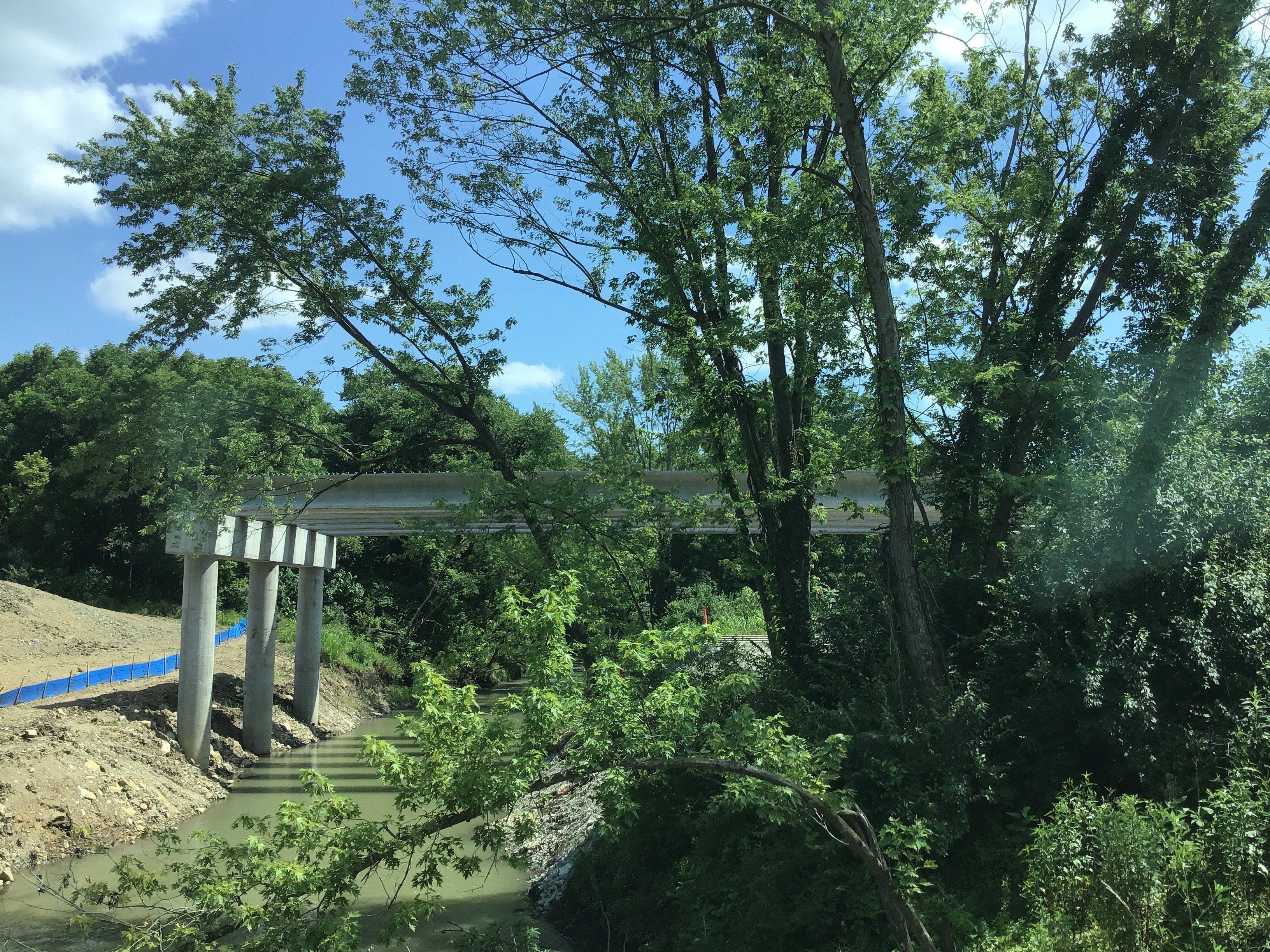

04/30/2021 image.jpg35
04/30/2021 64148793190__19434802-5D22-47EF-8ECD-A2BC8A7784F1.MOV
05/03/2021 Letter INSPECTION SUMMARY
05/04/2021 64185173893__CE5D8236-BF9E-4A34-8233-D6BF71BE14D3.MOV
05/04/2021 Letter INSPECTION SUMMARY
05/07/2021 64209434877__F8A1C927-0A1B-495A-90ED-0213E9D58E54.MOV
05/24/2021 64357303662__14701220-FA1B-416C-9402-F637764D2F2A.MOV

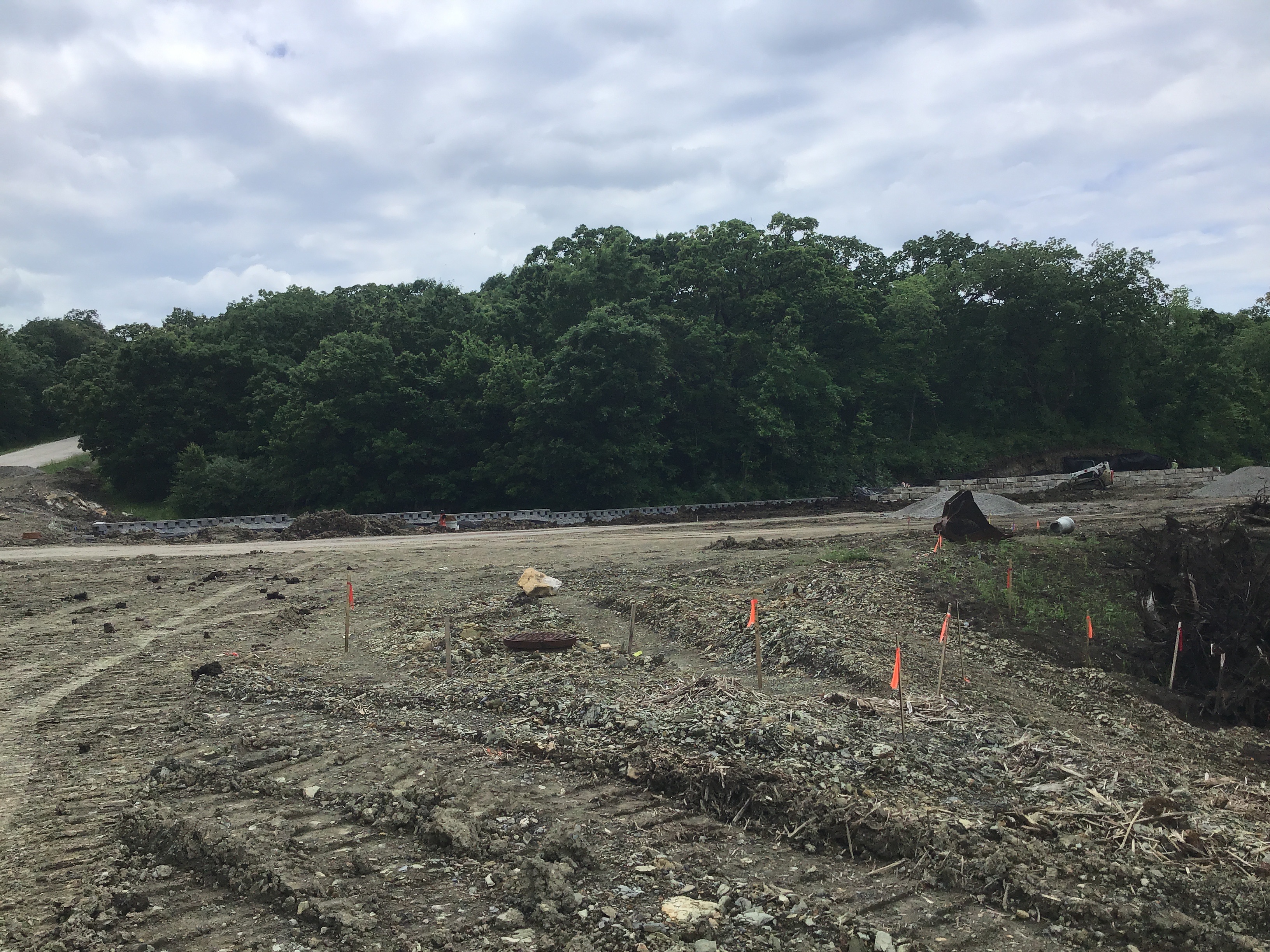

05/25/2021 image.jpg36
05/25/2021 64365369360__27841CD4-F55C-4825-8431-6736EABB4599.MOV
05/25/2021 image.jpg37
05/25/2021 64365428591__1527E981-7755-4378-9D51-A07FB8008C51.MOV
06/01/2021 64426985599__2F93B4F7-D1F1-4B1E-8E9C-6AE85A6605CE.MOV
06/01/2021 image.jpg38
06/01/2021 image.jpg39
06/02/2021 64433911902__B7DB0AFE-7FD4-4CA6-B741-B40A1A1E5EEB.MOV
06/02/2021 64433916088__45537AF5-1C32-4A7C-B891-74B4EA1CC528.MOV
06/09/2021 64494579744__380BEC04-8352-427D-BB75-65D81A190E49.MOV

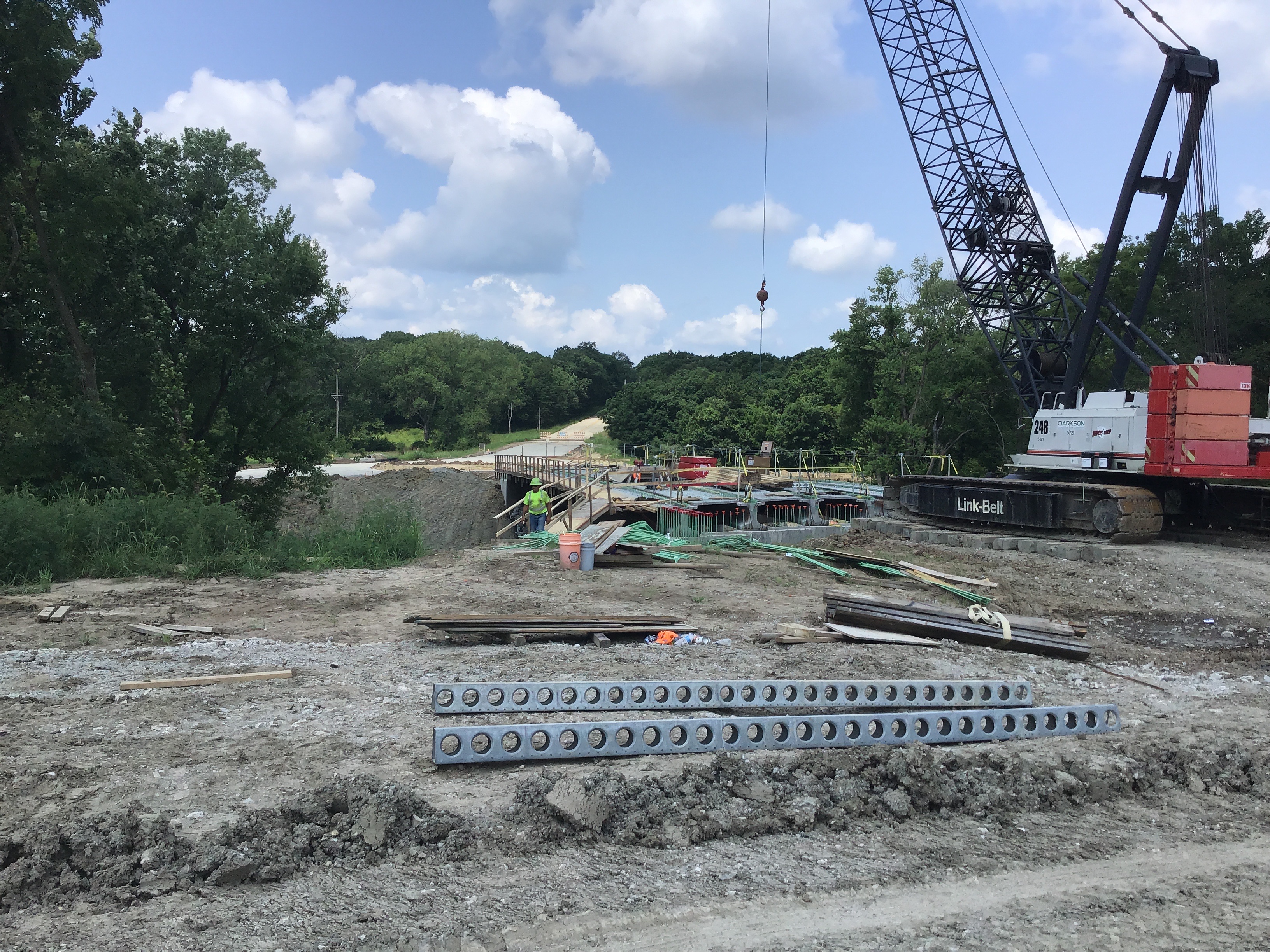

06/10/2021 image.jpg40
06/14/2021 image.jpg41
06/15/2021 image.jpg42
06/15/2021 image.jpg43
06/16/2021 image.jpg44
06/17/2021 64563503644__AB4CB87D-E5F8-4391-925C-6E3A0E93AF2F.MOV
06/17/2021 Letter INSPECTION SUMMARY
06/17/2021 Letter INSPECTION SUMMARY
06/18/2021 image.jpg45
06/18/2021 image.jpg46
06/23/2021 Letter INSPECTION SUMMARY
06/23/2021 Letter INSPECTION SUMMARY
06/25/2021 image.jpg47
06/25/2021 image.jpg48
07/06/2021 image.jpg49
07/06/2021 image.jpg50
07/08/2021 image.jpg51
07/09/2021 64754216161__1A93DAC2-8B55-4D1C-9213-2214AD837C8F.MOV
07/09/2021 image.jpg52
07/09/2021 image.jpg53
07/09/2021 64754301662__96549709-5C42-4589-A6B9-F6382328979F.MOV
07/09/2021 image.jpg54
07/09/2021 image.jpg55
07/09/2021 image.jpg56
07/12/2021 image.jpg57
07/13/2021 image.jpg58
07/14/2021 64796594396__DF72E9AF-F43A-4296-8D57-451D82608C62.MOV
07/19/2021 image.jpg59
07/19/2021 image.jpg60
07/27/2021 image.jpg61
07/29/2021 image.jpg62
08/19/2021 image.jpg63
08/20/2021 image.jpg64
08/26/2021 image.jpg65
08/26/2021 image.jpg66
09/07/2021 image.jpg67
09/14/2021 image.jpg68
09/16/2021 image.jpg69
09/23/2021 image.jpg70
09/23/2021 image.jpg71
09/23/2021 image.jpg72
09/23/2021 image.jpg73
09/23/2021 image.jpg74
09/24/2021 image.jpg75

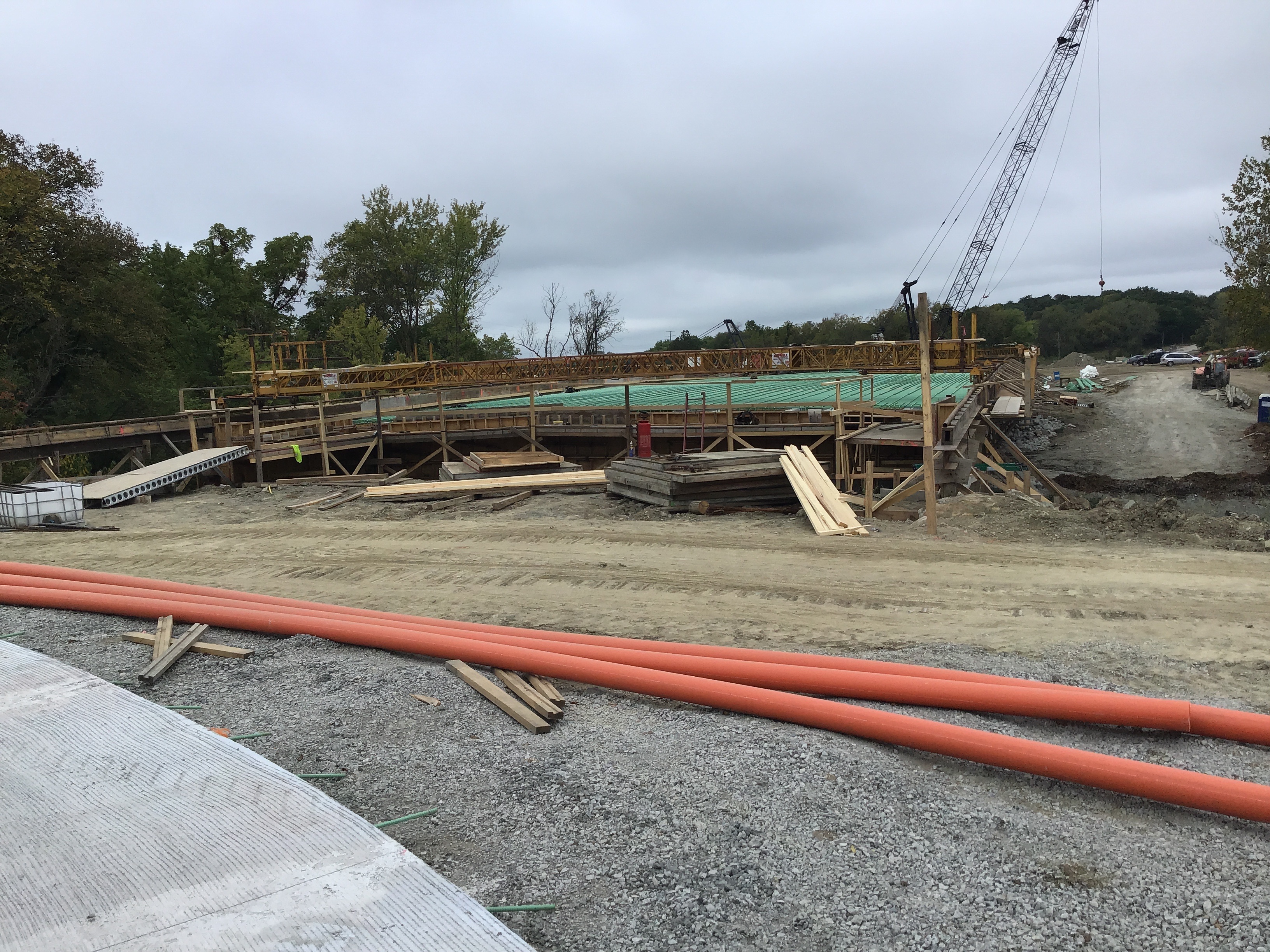

09/30/2021 West Bridge & Abutment .jpg
09/30/2021 image.jpg76
10/01/2021 image.jpg77
10/18/2021 image.jpg78
10/20/2021 image.jpg79
10/20/2021 image.jpg80
10/20/2021 image.jpg81
10/20/2021 image.jpg82
10/20/2021 image.jpg83
10/20/2021 image.jpg84
10/21/2021 image.jpg85
01/28/2022 Approved Plans Paragon Star East Bridge Addendum Approved
01/28/2022 Approved Plans Paragon Star West Bridge Addendum Approved
12/05/2022 Receipt Receipt for transaction: 2022-009265
12/08/2022 Approved Plans Approved Village Private Street and Utilities
12/08/2022 Approved Plans Approved Village FDP 2020_11_04_PL2019306_Village
12/15/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/16/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/19/2022 Letter INSPECTION SUMMARY
12/20/2022 Letter INSPECTION SUMMARY
08/19/2024 Email Permit PRSITE20203248 - 2_ Water Meter
08/26/2024 Receipt Receipt for transaction:2024-007189
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
