Summary

PRSITE20193433
Development - Site
Final Acceptance
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
MCKEEVERS MARKET SITE DEVELOPMENT
11/21/2019
11/22/2019
07/08/2021
Locations
Contacts
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
CRANE CONSTRUCTION COMPANY, Address:PO BOX 298, Phone:(816) 324-5951
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 11/21/2019 11/21/2019
Development Center
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $79.43 $79.43 Paid Not payable online 11/21/2019
91100C9-Water Insp Fee $1,581.32 $1,581.32 Paid Not payable online 11/21/2019
9110072-Water Test Fee $200.00 $200.00 Paid Not payable online 11/21/2019
9110068-Storm Fee $1,847.00 $1,847.00 Paid Not payable online 11/21/2019
9110081-Paved Surface Inspection Fee $21,066.41 $21,066.41 Paid Not payable online 11/21/2019
9110071-Site Grading Fee $3,979.79 $3,979.79 Paid Not payable online 11/21/2019
$3,979.80
8350015-Water Meter Fee $2,457.66 $2,457.66 Paid Not payable online 01/09/2020
8331401-Water Tap Fee $23,180.00 $23,180.00 Paid Not payable online 01/09/2020
Outstanding Fees Amount Paid Owing Date Paid
9110080-Not Ready Inspection Fee $50.00 $0.00 $50.00 Not Paid
9110080-Not Ready Inspection Fee $50.00 $0.00 $50.00 Not Paid

$100.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Pavement-Stabilized Subgrade Partial 11/25/2019
Misc
Informational
11/25/2019
11-22-19 They have put in all of the fly ash and rolled it out.
Pavement-Proof Roll Partial 11/25/2019 11/25/2019
Misc
Informational
11/25/2019
11-25-19 7:49am The proof roll was for 7:30am the truck is not on site at this time.
Misc
Informational
11/25/2019
11-25-19 7:49am The proof roll was for 7:30am the truck is not on site at this time. 8:00am They got a truck. We proof rolled the parking lot and the road that goes around the building. They are making corrections around the two storm boxes at the south end of the parking lot. They will be making corrections around the storm boxes at the west end of the site as well. Everything else passed. They are going to add geo grid to help with failed areas.
Pavement-Stabilized Subgrade Partial 11/26/2019 11/26/2019
Misc
Informational
11/25/2019
11-22-19 They have put in all of the fly ash and rolled it out.
Misc
Informational
11/26/2019
11-26-19 They have placed geo grid around storm boxes along with fly ash. They are laying base rock over the parking lot.
Miscellaneous PWORKS Inspection Passed 12/23/2019 at 10:00 AM 12/23/2019
Misc
Informational
12/23/2019
The contractor installed the irrigation/drain pipe into all the islands that are in the parking lot. They are now clear to backfill.

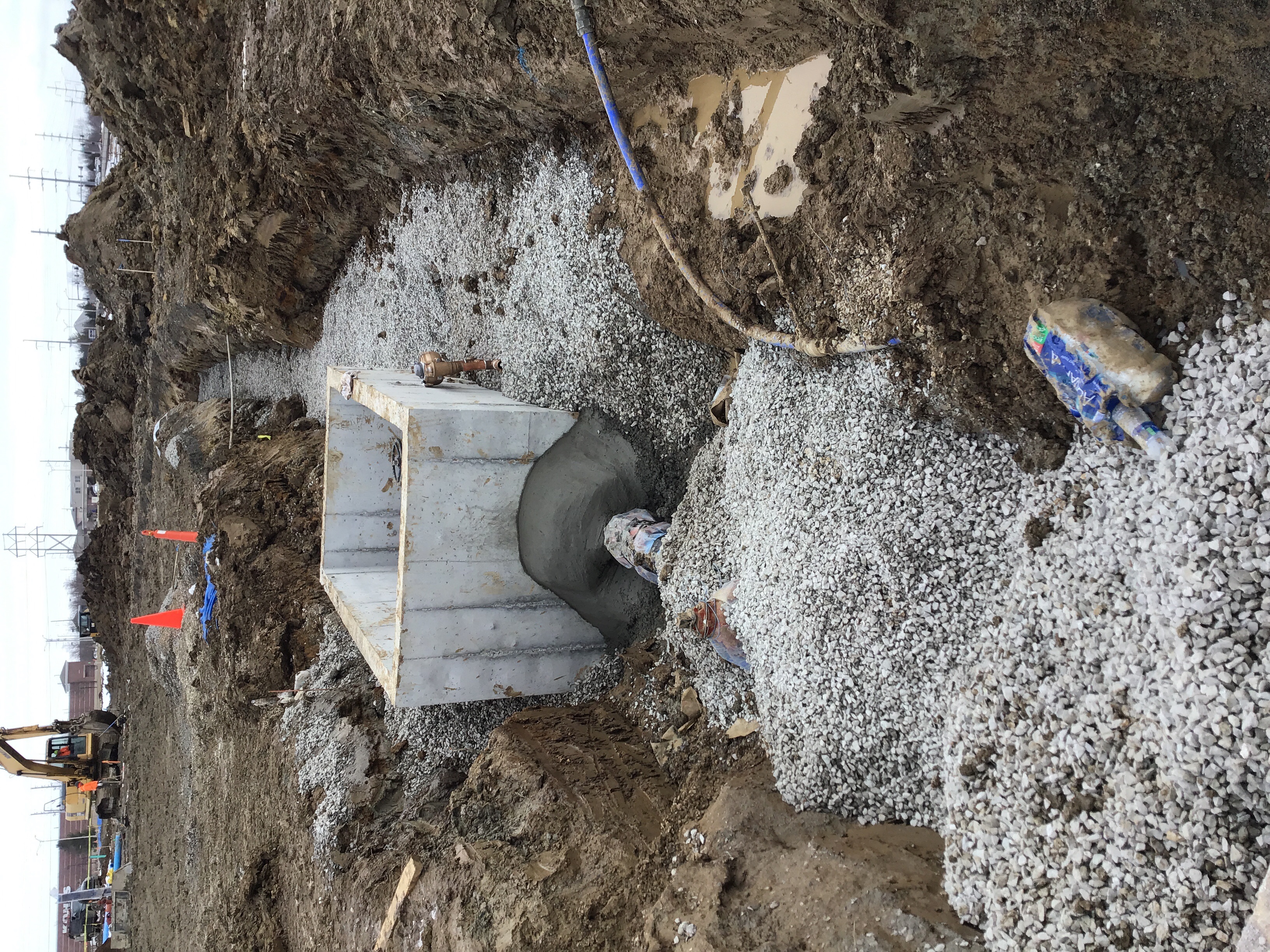

Storm - Pipe Partial 1/21/2020 01/21/2020
Misc
Informational
01/21/2020
3:08pm 1/21/20 They are installing roof drains across the road and will get compaction test at a later date.
Sanitary Sewer Construction Inspection Partial 1/21/2020 01/21/2020
Misc
Informational
01/21/2020

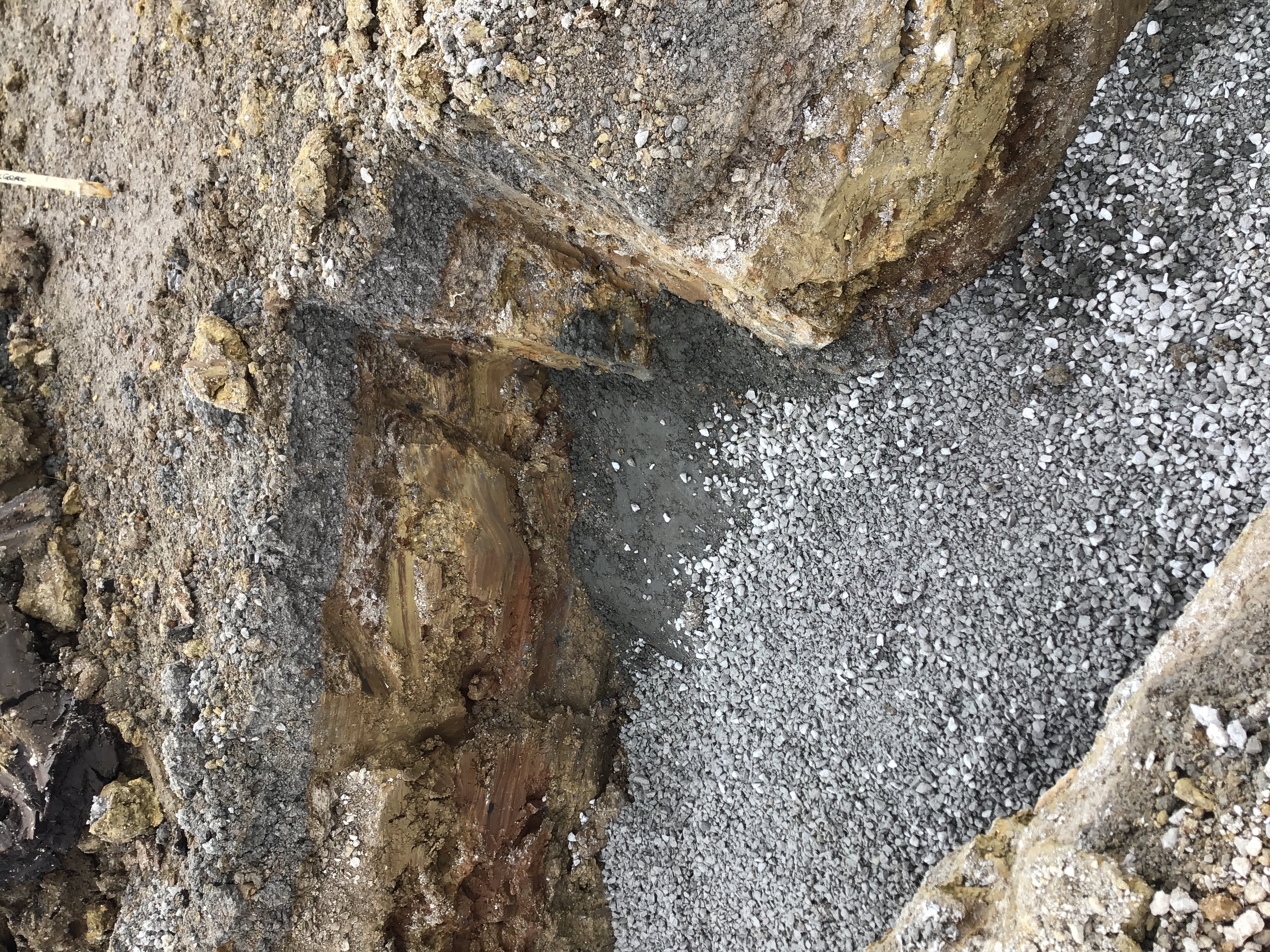

1-21-20 They have dug down to the main and installed the wye. They are now digging out for the service line.
Storm - Pipe Partial 1/23/2020 01/23/2020
Misc
Informational
01/21/2020
3:08pm 1/21/20 They are installing roof drains across the road and will get compaction test at a later date.
Misc
Informational
01/23/2020
1-23-20 8:51am Kat is digging and installing roof drains from the parking lot to the building. They are currently crossing the road and will get compaction test at a later date in order to keep the road open at this time.
Sanitary Sewer Construction Inspection Partial 1/27/2020 01/27/2020
Misc
Informational
01/23/2020
1-21-20 They have dug down to the main and installed the wye. They are now digging out for the service line.
Misc
Informational
01/27/2020
1-27-20 9:45am They are digging out for the grease interceptors.
Storm - Pipe Partial 1/27/2020 01/27/2020
Misc
Informational
01/23/2020
3:08pm 1/21/20 They are installing roof drains across the road and will get compaction test at a later date.
Misc
Informational
01/23/2020
1-23-20 8:51am Kat is digging and installing roof drains from the parking lot to the building. They are currently crossing the road and will get compaction test at a later date in order to keep the road open at this time.
Misc
Informational
01/27/2020
1-27-20 They have installed storm pipe behind the loading dock.
Sanitary Sewer Construction Inspection Partial 01/28/2020
Misc
Informational
01/28/2020
1-28-20 10:30am They have installed the sanitary service line to the grease intercepter.
Sanitary - Material Verification Passed 1/29/2020 01/29/2020
Misc
Informational
01/29/2020
1-29-20 All material appears to be correct for the job.

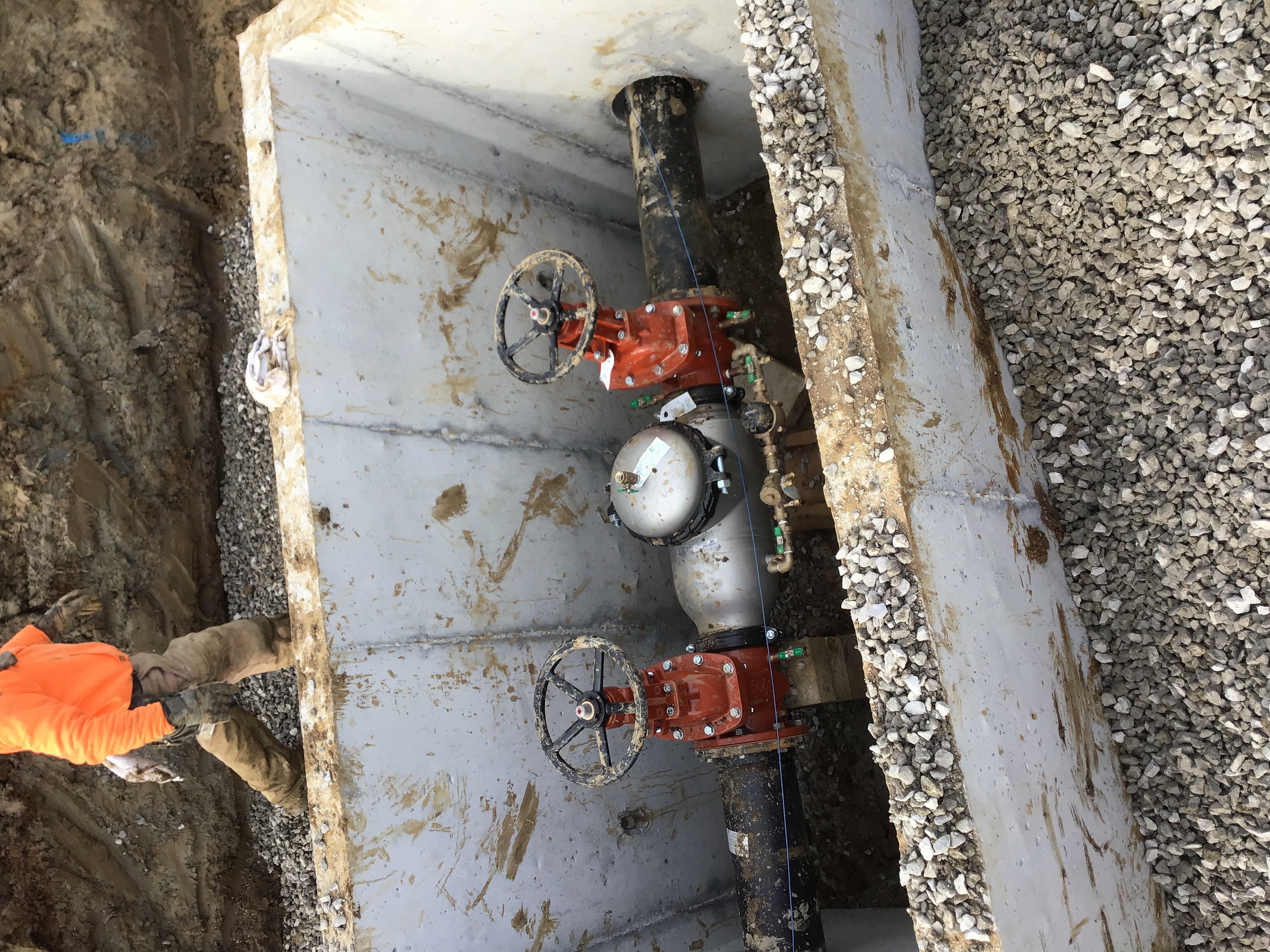

Water Line - Construction Inspection Partial 1/30/2020 01/30/2020
Misc
Informational
01/30/2020

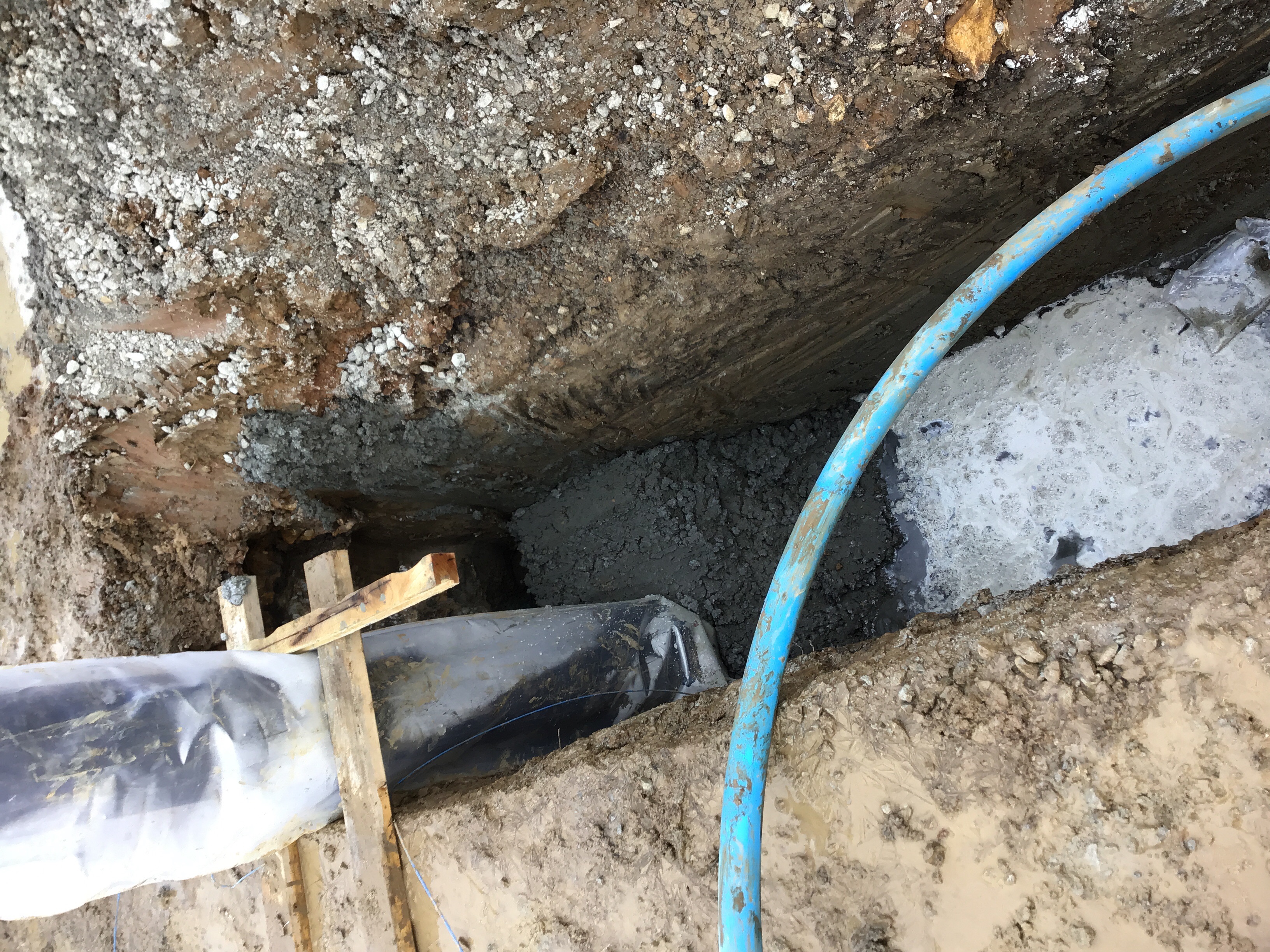

1-30-20 10:15am They have set the vault for the fireline and have approximately 30’ of waterline coming out of the vault at this time. 3:03pm They have approximately 130’ of waterline installed and collars poured at the vault for the F/L. They have one thrust block poured for a 45 and are working on installing more pipe. The meter for the 2inch is on site but not installed.
Water Line - Construction Inspection Partial 1/31/2020 01/31/2020
Misc
Informational
01/31/2020

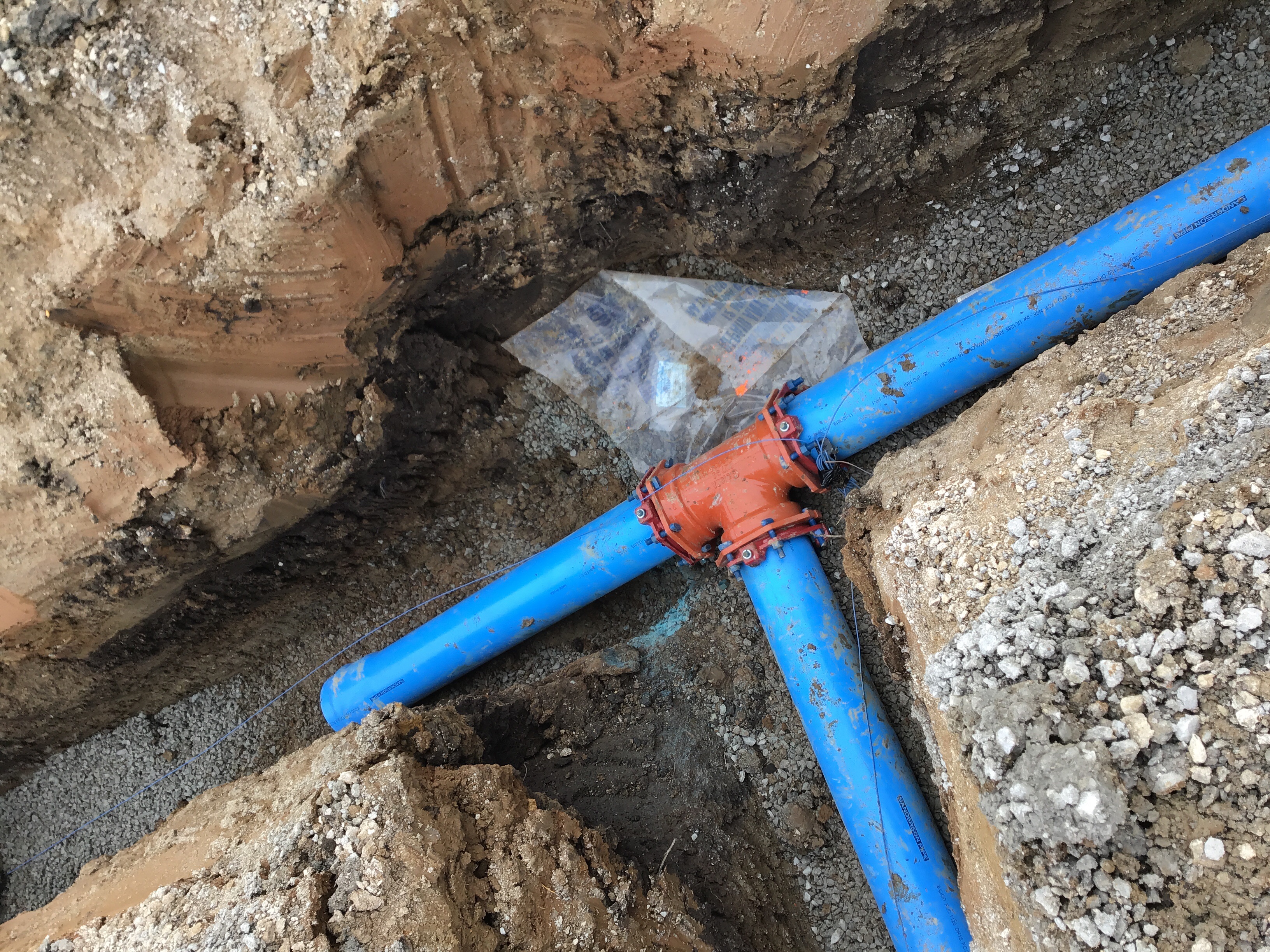

1-31-20 9:28am Kat Excavation is doing the work. They have ran the 2” waterline into the meter and out to the building. The meter is set. They have rocked and backfilled the majority of the line.
Site Visit Partial 2/10/2020 02/10/2020
Misc
Informational
02/10/2020
2-10-20 They are working on the building. There are no crews working that will require inspections from me at this time.
Erosion Control Inspection Partial 2/21/2020 02/21/2020
Misc
Informational
02/21/2020
2-21-20 10:20am There are no erosion control issues on this site.
Water Line - Hydrostatic Test Not Ready 4/3/2020 04/03/2020
Misc
Informational
04/03/2020

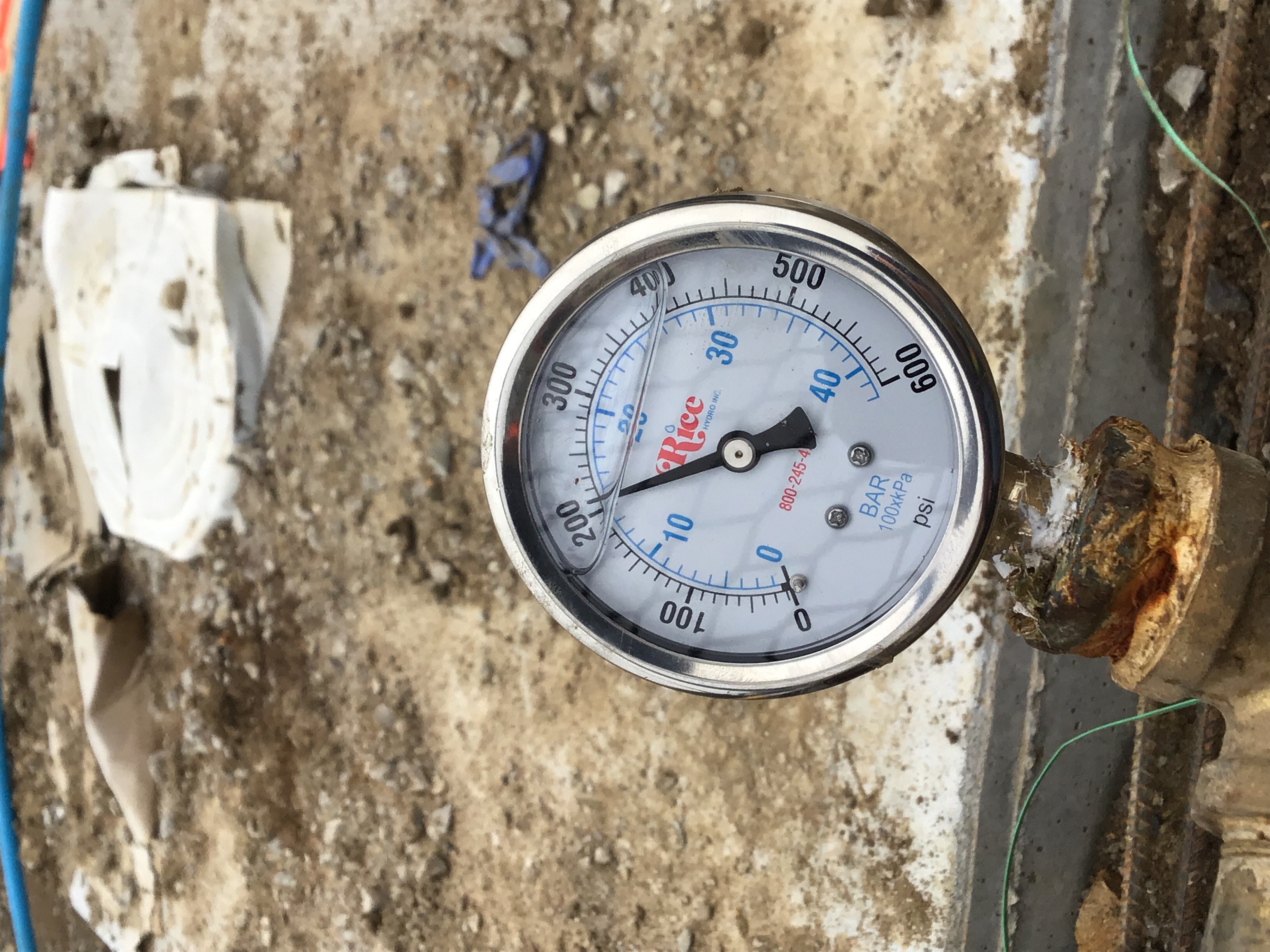

4-3-20 They were trying to test the fire line but the gauge they were using is not certified. We will try again at a later date.
Water Line - Hydrostatic Test Passed 4/6/2020 04/06/2020
Misc
Informational
04/03/2020
4-3-20 They were trying to test the fire line but the gauge they were using is not certified. We will try again at a later date.
Misc
Informational
04/06/2020

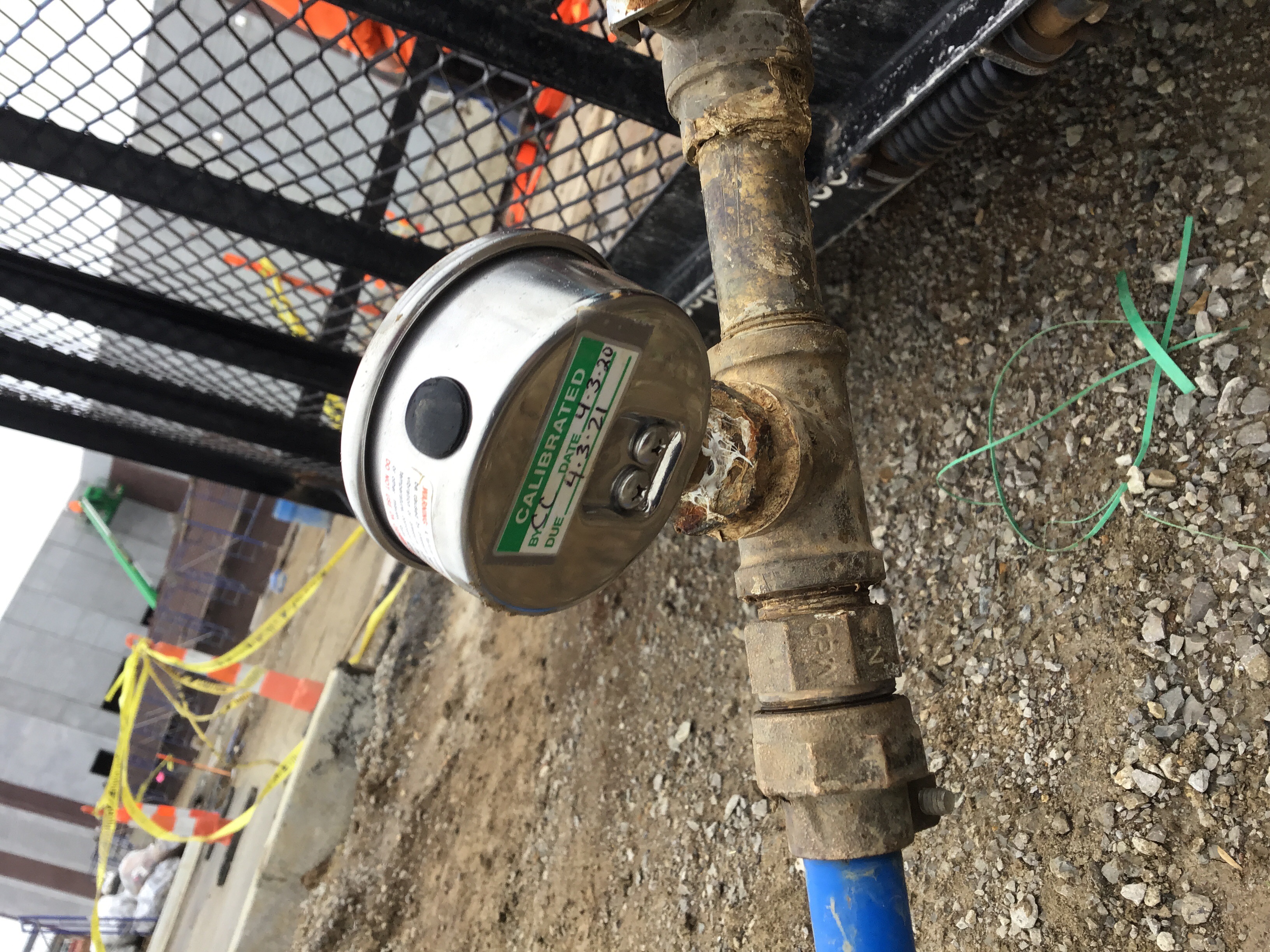

4-6-20 8:50am Kat Excavation has hooked up a certified pressure gauge on the fire line. It is at 200 psi and we will check it again in two hours.
Misc
Informational
04/06/2020
4-6-20 8:50am Kat Excavation has hooked up a certified pressure gauge on the fire line. It is at 200 psi and we will check it again in two hours.
Misc
Informational
04/06/2020
4-6-20 8:50am Kat Excavation has hooked up a certified pressure gauge on the fire line. It is at 200 psi and we will check it again in two hours. It has held just over 200 psi for two hours.
Water Line - Construction Inspection Partial 04/06/2020
Misc
Informational
01/31/2020
1-31-20 9:28am Kat Excavation is doing the work. They have ran the 2” waterline into the meter and out to the building. The meter is set. They have rocked and backfilled the majority of the line.
Misc
Informational
04/06/2020
4-6-20 10:59am They are flushing the fire line. They flushed for approximately 15 minutes.
Curb - Proof Roll Not Ready 04/15/2020
Misc
Informational
04/15/2020
4-15-20 9:52am The truck for the proof roll onl;y had a 9 ton load on.
Curb - Proof Roll Passed 4/15/2020 04/15/2020
Misc
Informational
04/15/2020
4-15-20 9:52am The truck for the proof roll onl;y had a 9 ton load on. 11:30am They had a 31 ton load and all curb line passed.

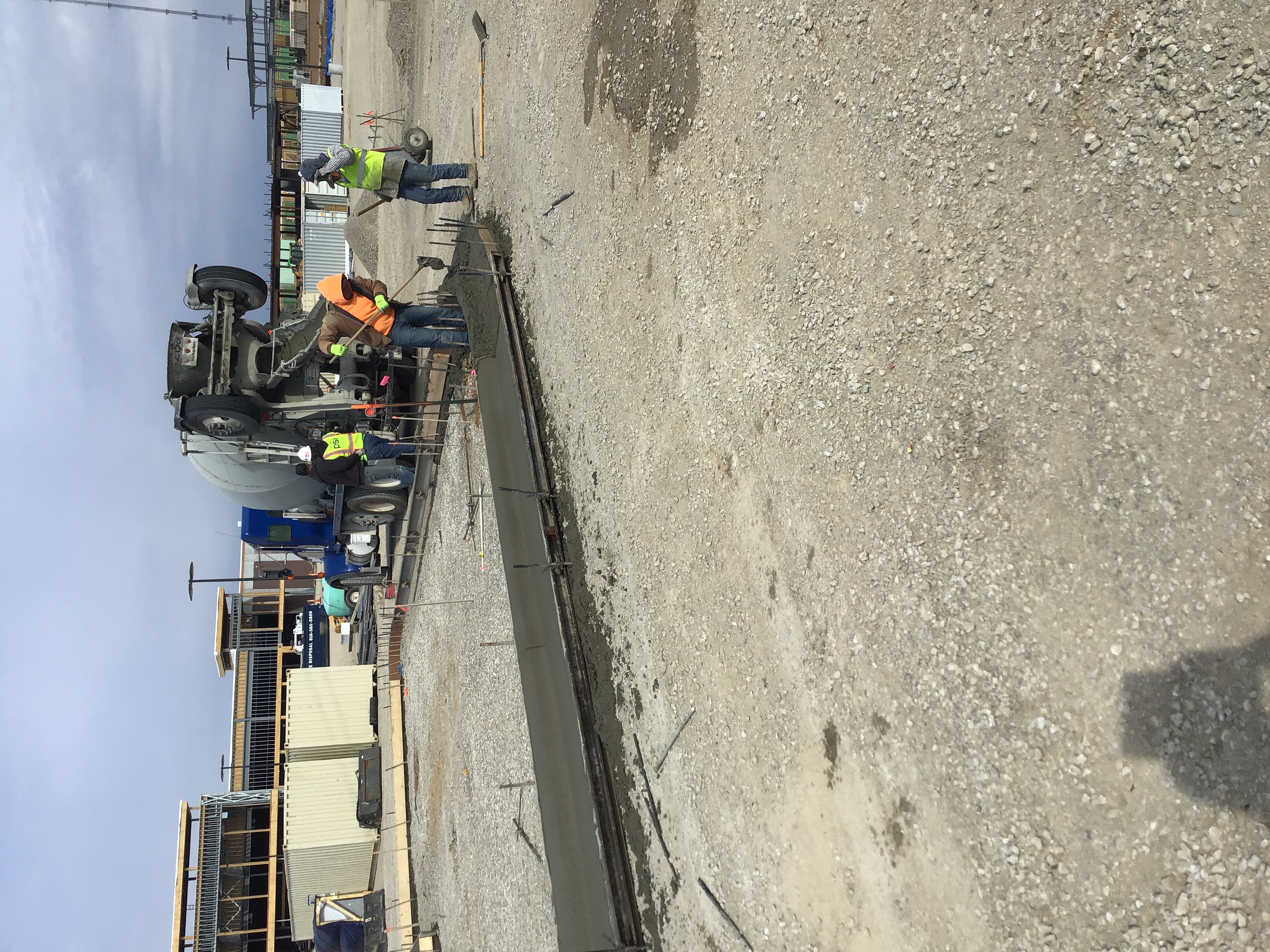

Pavement-Curb Construction Partial 4/16/2020 04/16/2020
Misc
Informational
04/16/2020

4-16-20 9:59AM They have started pouring curb for the islands. PSI is on site doing the testing. Freedom concrete is doing the work. 1:44pm They have 3 islands poured at this time. 2:52pm They are curing the islands again. The cure was applied to light. They will be covering with plastic due to rain moving in.
Pavement-Curb Construction Partial 4/21/2020 04/21/2020
Misc
Informational
04/16/2020
4-16-20 9:59AM They have started pouring curb for the islands. PSI is on site doing the testing. Freedom concrete is doing the work. 1:44pm They have 3 islands poured at this time. 2:52pm They are curing the islands again. The cure was applied to light. They will be covering with plastic due to rain moving in.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Pavement-Curb Construction Partial 5/1/2020 05/01/2020
Misc
Informational
04/21/2020
4-16-20 9:59AM They have started pouring curb for the islands. PSI is on site doing the testing. Freedom concrete is doing the work. 1:44pm They have 3 islands poured at this time. 2:52pm They are curing the islands again. The cure was applied to light. They will be covering with plastic due to rain moving in.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Misc
Informational
04/21/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Sidewalk Inspection Partial 05/14/2020
Misc
Informational
05/14/2020
5-14-20 They have set up forms and will be pouring sidewalk at the SE corner.
Water Line - Coliform Test 1 Partial 06/10/2020
Misc
Informational
06/10/2020
Coliform test was done on 6/10/20 Monday. Waiting on result of test.

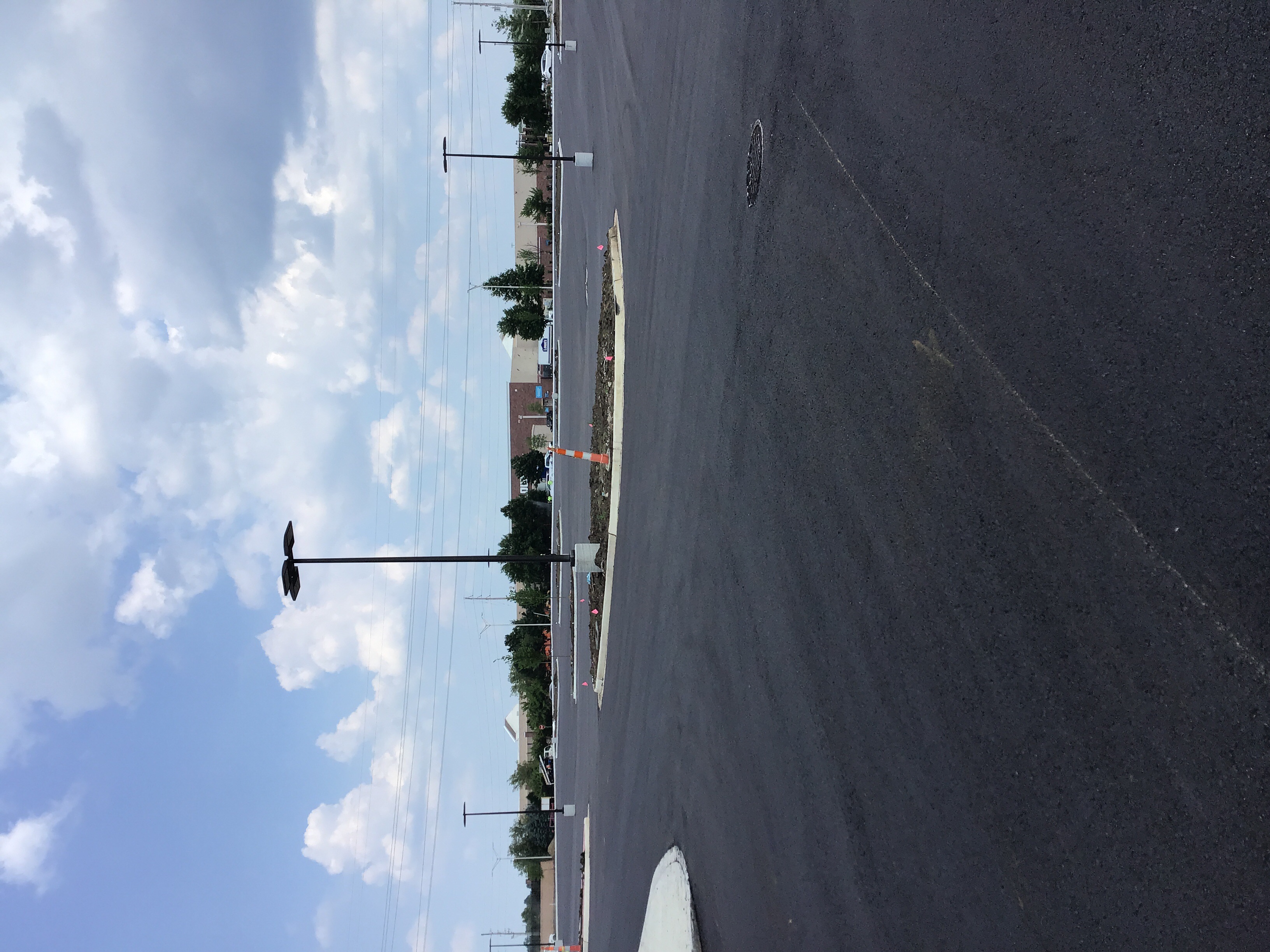

Proof roll parking lot Partial 6/29/2020 6/29/2020 06/29/2020
Misc
Informational
06/29/2020
6-29-20 8:30am The proof roll passed. It is subject for a second proof roll if it rains.
Pavement-Surface Partial 7/1/2020 7/1/2020 07/01/2020
Misc
Informational
07/01/2020

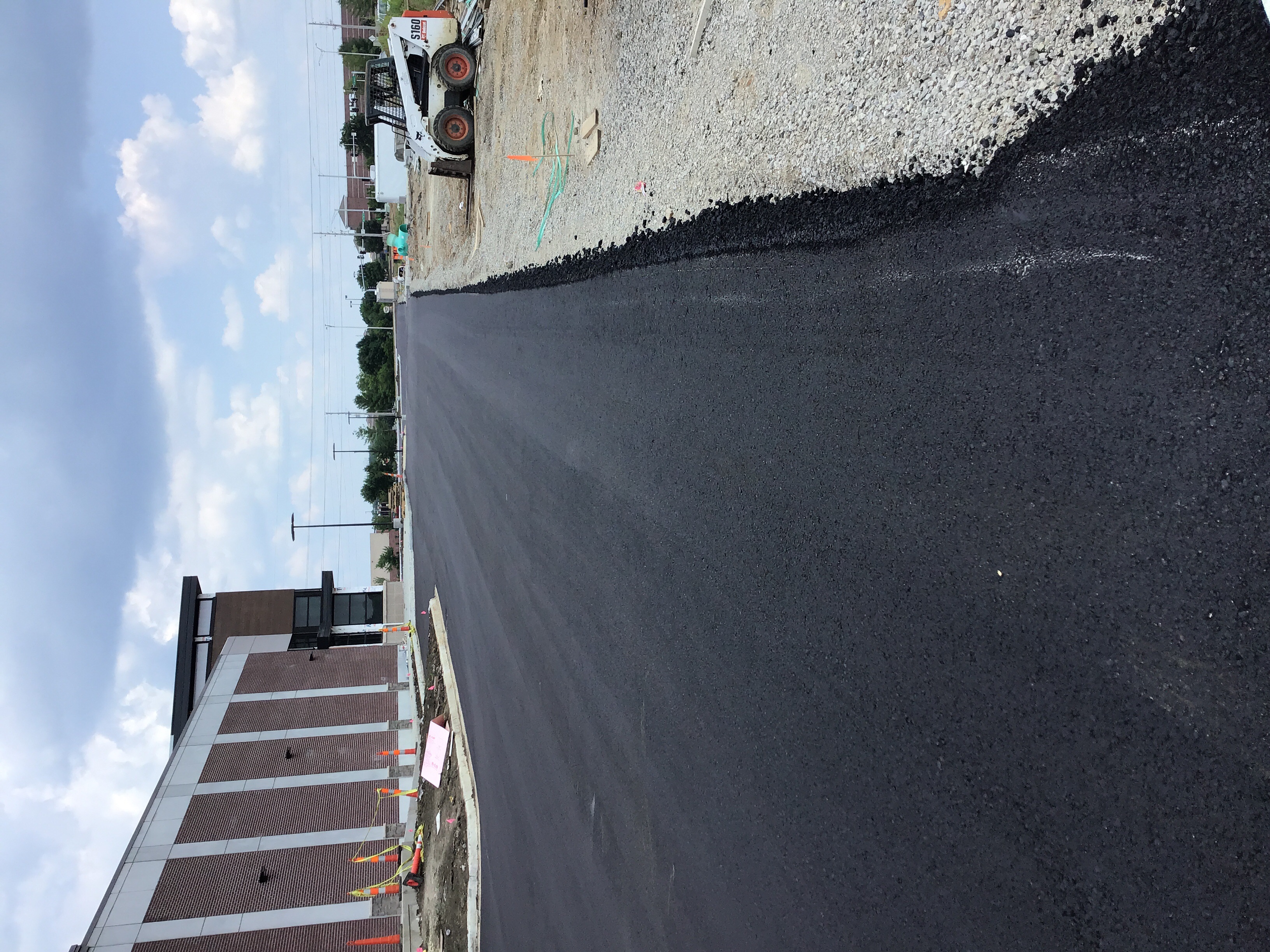

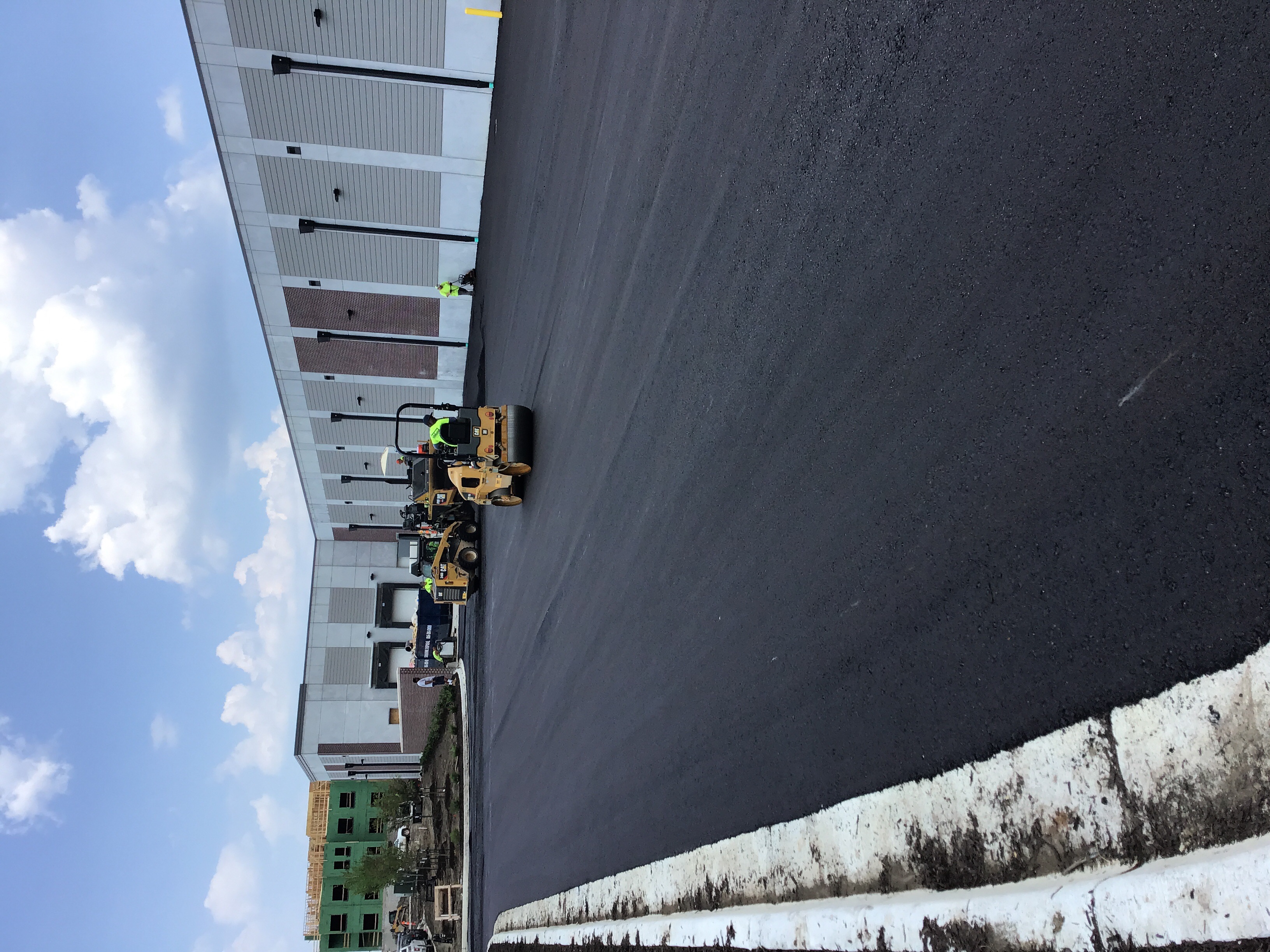

7-1-20 8:51am They are wanting to lay asphalt today at 12 noon. Due to weather this may not be possible. I will check the base again at approximately 11:30am. 1:39pm I have talked to the superintendent and they are going to lay asphalt on 7-2-20 at 8am.
Pavement-Surface Partial 7/2/2020 7/2/2020 07/02/2020
Misc
Informational
07/01/2020
7-1-20 8:51am They are wanting to lay asphalt today at 12 noon. Due to weather this may not be possible. I will check the base again at approximately 11:30am. 1:39pm I have talked to the superintendent and they are going to lay asphalt on 7-2-20 at 8am. 7-2-20 Seal-O-Matic is on site and have started laying asphalt in the North East corner of the parking lot. They are using Type 1 for base per plan. The temps out of the truck are approximately 270 degrees. They are not giving out tickets due to the virus.
Misc
Informational
07/02/2020
7-2-20 1:45 PM John DiMauro Seal-O-Matic is on site continuing the base lift for the parking lot. They are using Type 1 for base. The temps out of the truck are approximately 290 degrees. Not collecting tickets due to COVID - 19.
Pavement-Surface Partial 7/6/2020 7/6/2020 07/06/2020
Misc
Informational
07/02/2020
7-1-20 8:51am They are wanting to lay asphalt today at 12 noon. Due to weather this may not be possible. I will check the base again at approximately 11:30am. 1:39pm I have talked to the superintendent and they are going to lay asphalt on 7-2-20 at 8am. 7-2-20 Seal-O-Matic is on site and have started laying asphalt in the North East corner of the parking lot. They are using Type 1 for base per plan. The temps out of the truck are approximately 270 degrees. They are not giving out tickets due to the virus.
Misc
Informational
07/02/2020
7-2-20 1:45 PM John DiMauro Seal-O-Matic is on site continuing the base lift for the parking lot. They are using Type 1 for base. The temps out of the truck are approximately 290 degrees. Not collecting tickets due to COVID - 19. 7-6-20 7:37am Seal-O-matic is on site getting ready to lay more base asphalt on the south side of the site heading to the west. PIS is on site for testing.
Street - Surface Course Partial 7/7/2020 7/7/2020 07/07/2020
Misc
Informational
07/07/2020
7-7-20 7:30am Seal-O-Matic has surface on NE half of the parking lot. They are getting ready to start lay more surface after some prep work. Six asphalt trucks are now on site for surface. They are using Type 3 and temperature out of the trucks are approximately 260 degrees. They have sprayed tac coat and are now laying to the west.
Misc
Informational
07/07/2020
7-7-20 7:30am Seal-O-Matic has surface on NE half of the parking lot. They are getting ready to start lay more surface after some prep work. Six asphalt trucks are now on site for surface. They are using Type 3 and temperature out of the trucks are approximately 260 degrees. They have sprayed tac coat and are now laying to the west. 10:33am They have two more passed on the parking lot before they will be moving to the south side road and work there way to the west. 2:23pm They are on the west side of the building laying to the north by the dock. 3:07pm They are rapping up with the asphalt for the parking lot.
Site Visit Partial 07/13/2020
Misc
Informational
02/10/2020
2-10-20 They are working on the building. There are no crews working that will require inspections from me at this time. 7-13-20 7:46am I spoke with the superintendent about a asphalt curb on the south side of the site.There are no inspections needed at this time.
Street - Surface Course Passed 09/01/2020
Misc
Informational
07/07/2020
7-7-20 7:30am Seal-O-Matic has surface on NE half of the parking lot. They are getting ready to start lay more surface after some prep work. Six asphalt trucks are now on site for surface. They are using Type 3 and temperature out of the trucks are approximately 260 degrees. They have sprayed tac coat and are now laying to the west.
Misc
Informational
07/07/2020
7-7-20 7:30am Seal-O-Matic has surface on NE half of the parking lot. They are getting ready to start lay more surface after some prep work. Six asphalt trucks are now on site for surface. They are using Type 3 and temperature out of the trucks are approximately 260 degrees. They have sprayed tac coat and are now laying to the west. 10:33am They have two more passed on the parking lot before they will be moving to the south side road and work there way to the west. 2:23pm They are on the west side of the building laying to the north by the dock. 3:07pm They are rapping up with the asphalt for the parking lot.
Pavement-Surface Passed 09/01/2020
Misc
Informational
07/06/2020
7-1-20 8:51am They are wanting to lay asphalt today at 12 noon. Due to weather this may not be possible. I will check the base again at approximately 11:30am. 1:39pm I have talked to the superintendent and they are going to lay asphalt on 7-2-20 at 8am. 7-2-20 Seal-O-Matic is on site and have started laying asphalt in the North East corner of the parking lot. They are using Type 1 for base per plan. The temps out of the truck are approximately 270 degrees. They are not giving out tickets due to the virus.
Misc
Informational
07/06/2020
7-2-20 1:45 PM John DiMauro Seal-O-Matic is on site continuing the base lift for the parking lot. They are using Type 1 for base. The temps out of the truck are approximately 290 degrees. Not collecting tickets due to COVID - 19. 7-6-20 7:37am Seal-O-matic is on site getting ready to lay more base asphalt on the south side of the site heading to the west. PIS is on site for testing.
Proof roll parking lot Passed 09/01/2020
Misc
Informational
06/29/2020
6-29-20 8:30am The proof roll passed. It is subject for a second proof roll if it rains.
Sidewalk Inspection Passed 09/01/2020
Misc
Informational
05/14/2020
5-14-20 They have set up forms and will be pouring sidewalk at the SE corner.
Pavement-Curb Construction Passed 09/01/2020
Misc
Informational
05/01/2020
4-16-20 9:59AM They have started pouring curb for the islands. PSI is on site doing the testing. Freedom concrete is doing the work. 1:44pm They have 3 islands poured at this time. 2:52pm They are curing the islands again. The cure was applied to light. They will be covering with plastic due to rain moving in.
Misc
Informational
05/01/2020
4-21-20 9:16am They are pouring islands with the curb machine.
Misc
Informational
05/01/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Misc
Informational
05/01/2020
4-21-20 9:16am They are pouring islands with the curb machine. 2:19pm They have poured out with the machine and are working on hand pours.
Water Line - Construction Inspection Passed 09/01/2020
Misc
Informational
04/06/2020
1-31-20 9:28am Kat Excavation is doing the work. They have ran the 2” waterline into the meter and out to the building. The meter is set. They have rocked and backfilled the majority of the line.
Misc
Informational
04/06/2020
4-6-20 10:59am They are flushing the fire line. They flushed for approximately 15 minutes.
Storm - Pipe Passed 09/01/2020
Misc
Informational
01/27/2020
3:08pm 1/21/20 They are installing roof drains across the road and will get compaction test at a later date.
Misc
Informational
01/27/2020
1-23-20 8:51am Kat is digging and installing roof drains from the parking lot to the building. They are currently crossing the road and will get compaction test at a later date in order to keep the road open at this time.
Misc
Informational
01/27/2020
1-27-20 They have installed storm pipe behind the loading dock.
Pavement-Stabilized Subgrade Passed 09/01/2020
Misc
Informational
11/26/2019
11-22-19 They have put in all of the fly ash and rolled it out.
Misc
Informational
11/26/2019
11-26-19 They have placed geo grid around storm boxes along with fly ash. They are laying base rock over the parking lot.
Storm - Material Verification Passed 1/22/2020 09/01/2020
Water - Material Verification Passed 09/01/2020
Water - Material Verification Passed 09/01/2020
Storm - Inlets Clean Passed 09/01/2020
Storm - Material Verification Passed 09/01/2020
Sanitary Sewer Construction Inspection Passed 09/01/2020
Storm - Outlet Structure Passed 09/01/2020
Sanitary - Material Verification Passed 09/01/2020
Curb - Compression Strength Passed 09/01/2020
Street - Wedge Lift Passed 09/01/2020
Sanitary Sewer Construction Inspection Passed 09/01/2020
Water - Material Verification Passed 09/01/2020
Water - Material Verification Passed 09/04/2020
Install Street and Stop Signs Passed 09/04/2020
ESC - (Vegetation/Ground Cover) Passed 09/04/2020
Water Line - Fire Hydrant Passed 09/04/2020
Water Line - Valve Passed 09/04/2020
Grading/Excavation/Fill Inspection Passed 09/04/2020
Erosion Control Inspection Passed 11/06/2020
Misc
Informational
02/21/2020
2-21-20 10:20am There are no erosion control issues on this site.
Site Visit Complete 8/3/2020 11/06/2020
Misc
Informational
07/13/2020
2-10-20 They are working on the building. There are no crews working that will require inspections from me at this time. 7-13-20 7:46am I spoke with the superintendent about a asphalt curb on the south side of the site.There are no inspections needed at this time.
Documents & Images
Date Uploaded File Type Document Name
11/21/2019 Receipt Receipt for transaction: 2019-007426
11/25/2019 Letter INSPECTION SUMMARY
12/23/2019 Letter DE-Daily Inspection Summary
01/09/2020 Receipt Receipt for transaction: 2020-000110
01/10/2020 PTR_03533177-2-S1.rev_1
01/10/2020 PTR_03533177-2-S6.rev_1
01/10/2020 PTR_03533177-2-S3.rev_1
01/10/2020 PTR_03533177-2-S4.rev_1
01/21/2020 Roof Storm drain
01/28/2020 Letter INSPECTION SUMMARY
01/28/2020 Letter INSPECTION SUMMARY
01/28/2020 Letter INSPECTION SUMMARY
01/28/2020 Letter INSPECTION SUMMARY
01/29/2020 Letter INSPECTION SUMMARY
01/30/2020 VAULT FOR FIRELINE
01/30/2020 Vault
01/30/2020 Collar
01/30/2020 Thrust block
01/30/2020 Tee on the water line
01/30/2020 Letter INSPECTION SUMMARY
01/31/2020 Meter pit
01/31/2020 Hydrant thrust block
01/31/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter INSPECTION SUMMARY
02/21/2020 Letter DE-Permit
04/03/2020 Letter INSPECTION SUMMARY
04/06/2020 Certified pressure gauge
04/06/2020 Pressure gauge
04/06/2020 Letter INSPECTION SUMMARY
04/06/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/16/2020 Concrete ticket for curb
04/16/2020 Island curb
04/16/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/14/2020 Letter INSPECTION SUMMARY
06/10/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
07/01/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/07/2020 Back dock.jpg
07/07/2020 South side.jpg
07/07/2020 East parking lot .jpg
07/07/2020 Letter INSPECTION SUMMARY
07/13/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
09/01/2020 Letter INSPECTION SUMMARY
11/06/2020 McKeevers Substantial Completion
11/06/2020 McKeever Punch List
11/06/2020 Letter DE-Punch List
11/06/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
11/06/2020 McKeevers Substantial Completion - Signed
11/06/2020 McKeevers Punch List - Signed
07/08/2021 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
