Summary

PRSITE20192517
Development - Site
Final Acceptance
DEVELOPMENT COMPLETE

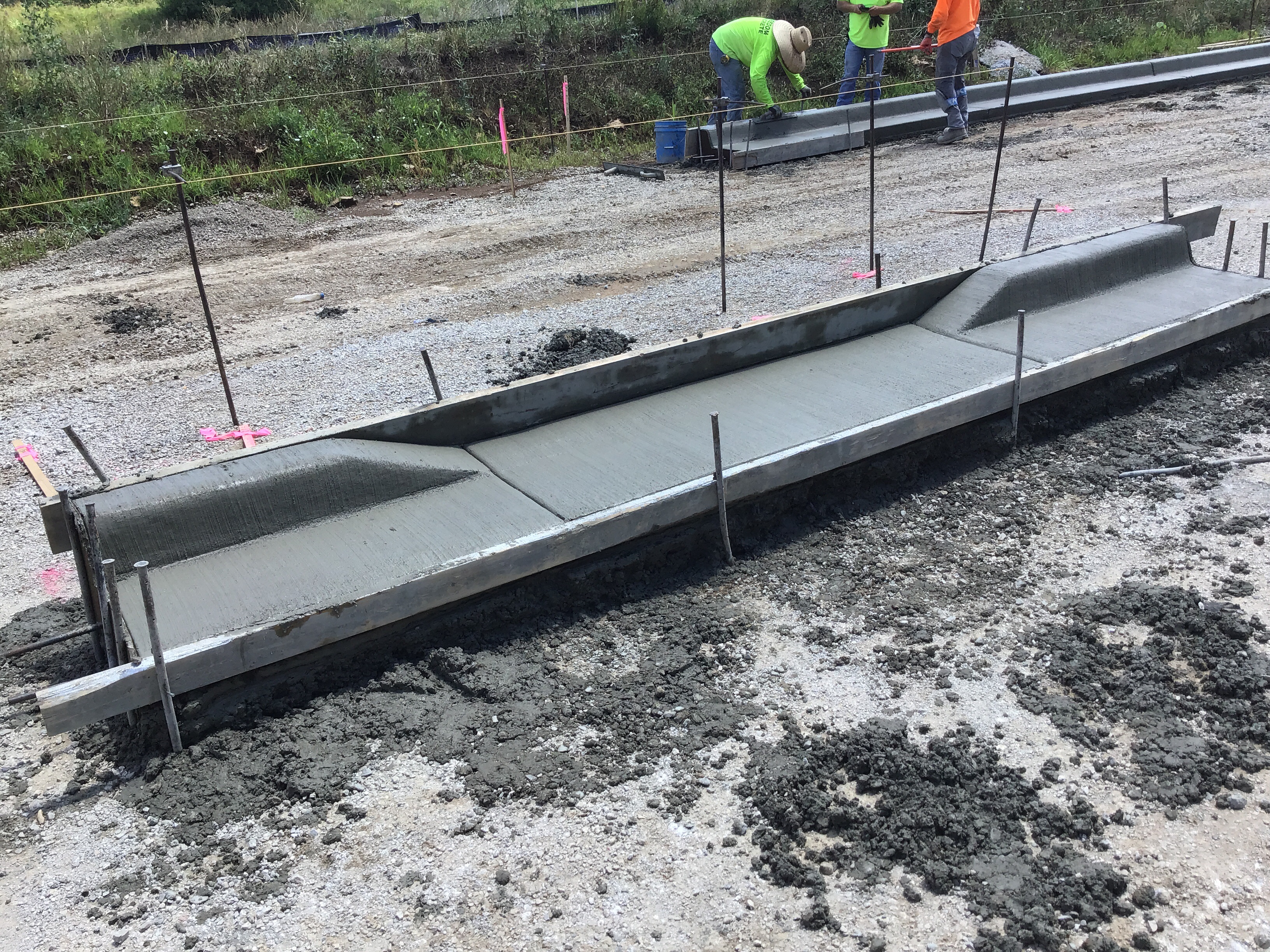

FULL SITE DEVELOPMENT
09/05/2019
09/11/2019
02/10/2021
Locations
Contacts
WARD DEVELOPMENT & INVESTMENT CO, Address:1120 NW EAGLE RIDGE BLVD, Phone:(816) 229-8115
KENT BILQUIST, Address:WARD DEVELOPMENT
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 09/05/2019 09/11/2019
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
9110073-Right of Way Permit Fee $80.00 $80.00 Paid Not payable online 09/05/2019
91100C8-Sanitary Sewer Insp Fees $20.70 $20.70 Paid Not payable online 09/05/2019
91100C9-Water Insp Fee $309.90 $309.90 Paid Not payable online 09/05/2019
9110072-Water Test Fee $200.00 $200.00 Paid Not payable online 09/05/2019
9110068-Storm Fee $1,564.92 $1,564.92 Paid Not payable online 09/05/2019
9110081-Paved Surface Inspection Fee $8,603.21 $8,603.21 Paid Not payable online 09/05/2019
$8,603.22
9110071-Site Grading Fee $3,520.13 $3,520.13 Paid Not payable online 09/05/2019
8350015-Water Meter Fee $469.90 $469.90 Paid Not payable online 09/05/2019
8331401-Water Tap Fee $5,795.00 $5,795.00 Paid Not payable online 09/05/2019
8331401-Water Tap Fee $5,795.00 $5,795.00 Paid 05/04/2020
$11,590.00
8350015-Water Meter Fee $469.90 $469.90 Paid 05/04/2020
$939.80
9110069-After Hours Inspections (Public Works)(Per Hour) $300.00 $300.00 Paid 10/22/2020
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $300.00 $0.00 $300.00 Not Paid

$300.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Grading/Excavation/Fill Inspection Partial 10/14/2019 10/14/2019
Informational
10/14/2019
Contractor has continued to grade site for approximately the pass 30 day.
Storm - Material Verification Passed 05/06/2020
Misc
Informational
05/06/2020
Reviewed storm materials that are onsite for installation for storm lines 1 thru 5.
Erosion Control Inspection Passed 05/28/2020
Misc
Informational
05/28/2020
Erosion control is still I place.
Fire Line - Hydrostatic Test Passed 06/05/2020
Misc
Informational
06/05/2020
Fire Line - 2 hour Hydrostatic test passed.
Water Line - Coliform Test 1 Partial 06/09/2020
Misc
Informational
06/09/2020
Collected the sample at 10:50 AM 6/9/20 Tuesday.
Sidewalk Inspection Passed 07/08/2020
Misc
Informational
07/08/2020
Sidewalk - passed final inspection.
Fire Line - Flush Passed 07/31/2020
Misc
Informational
07/31/2020
7/31/20 Friday Flush Fire line.
Driveway Inspection Passed 09/22/2020
Misc
Informational
07/20/2020
7/20/20 Monday Driveway & parking lot inspection of proof rolls were done for subgrade and after Geogrid was installed at the end of May 2020. Documents may have been accidentally recorded under the wrong permit. Inspector’s note of missing inspection John M. Jackson.
Curb - Proof Roll Passed 09/22/2020
Pavement-Proof Roll Passed 09/22/2020
Curb - Compression Strength Passed 09/22/2020
Misc
Informational
07/22/2020
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/06/2020
Contractor began to install storm line #1 starting at existing junction box. (Sta 0+00 to 1+18.64) Approximately 118’ feet of 24” HDPE was installed. STD 30” Nyoplast Curb Inlet was installed @ Sta 0+13.32 on Line #1.
Storm - Outlet Structure Passed 09/22/2020
Erosion Control Inspection Passed 09/22/2020
Storm - Inlets Clean Passed 09/22/2020
Retaining Wall Inspection Passed 09/22/2020
Sidewalk Inspection Passed 09/22/2020
Misc
Informational
07/06/2020
Sidewalk- forms and materials passed pre-inspection.
Sewer Service Inspection Passed 09/22/2020
Storm - Material Verification Passed 09/22/2020
Retaining Wall Inspection Passed 09/22/2020
Sidewalk Inspection Passed 7/9/2020 09/22/2020
Misc
Informational
08/10/2020
8/10/20 Monday foreman is asking if stair and sidewalk on the private side ( Eastside of ) project can be omitted . The inspector has advice the site to clear through the Engineers and I am not against this change. Refer to C200 these changes if allowed shall be reflect on the as-built.
Sewer Service Inspection Passed 09/22/2020
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/06/2020
Contractor began to install storm line 1 starting at existing junction box.
Misc
Informational
05/07/2020
Contractor installed approximately 70 feet of 24”HDPE & 20 feet of 18” HDPE on 5/7/20. On 5/6/20 approximately 118 feet of 24” HDPE. 3/30” Nyoplast curb inlet was installed at Sta. 0+13.32, 1+19.64, & 1+63.49 on storm line #1.
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/07/2020
Contractor began to install storm line 1 starting at existing junction box.
Misc
Informational
05/07/2020
Contractor installed approximately 70 feet of 24”HDPE & 20 feet of 18” HDPE on 5/7/20. On 5/6/20 approximately 118 feet of 24” HDPE. 3/30” Nyoplast curb inlet was installed at Sta. 0+13.32, 1+19.64, & 1+63.49 on storm line #1.
Misc
Informational
05/11/2020
Contractor installed approximately 25’ of 12”HDPE on Storm line #3. Contractor is installing approximately 79’ of 12” HDPE & 62’ of 8” HDPE Storm line #4.
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/13/2020
Contractor began to install storm line 1 starting at existing junction box.
Misc
Informational
05/13/2020
Contractor installed approximately 70 feet of 24”HDPE & 20 feet of 18” HDPE on 5/7/20. On 5/6/20 approximately 118 feet of 24” HDPE. 3/30” Nyoplast curb inlet was installed at Sta. 0+13.32, 1+19.64, & 1+63.49 on storm line #1.
Misc
Informational
05/13/2020
Contractor installed approximately 25’ of 12”HDPE on Storm line #3. Contractor is installing approximately 79’ of 12” HDPE & 62’ of 8” HDPE Storm line #4.
Misc
Informational
05/18/2020
Contractor cored into existing storm line & installed approximately 12” HDPE 148’ of Nyoplast Junction JB-2-1, JB-2-3 & Nyoplast Curb Inlet A1-2-2.
Fire Line Construction Inspection Passed 09/22/2020
Misc
Informational
05/13/2020

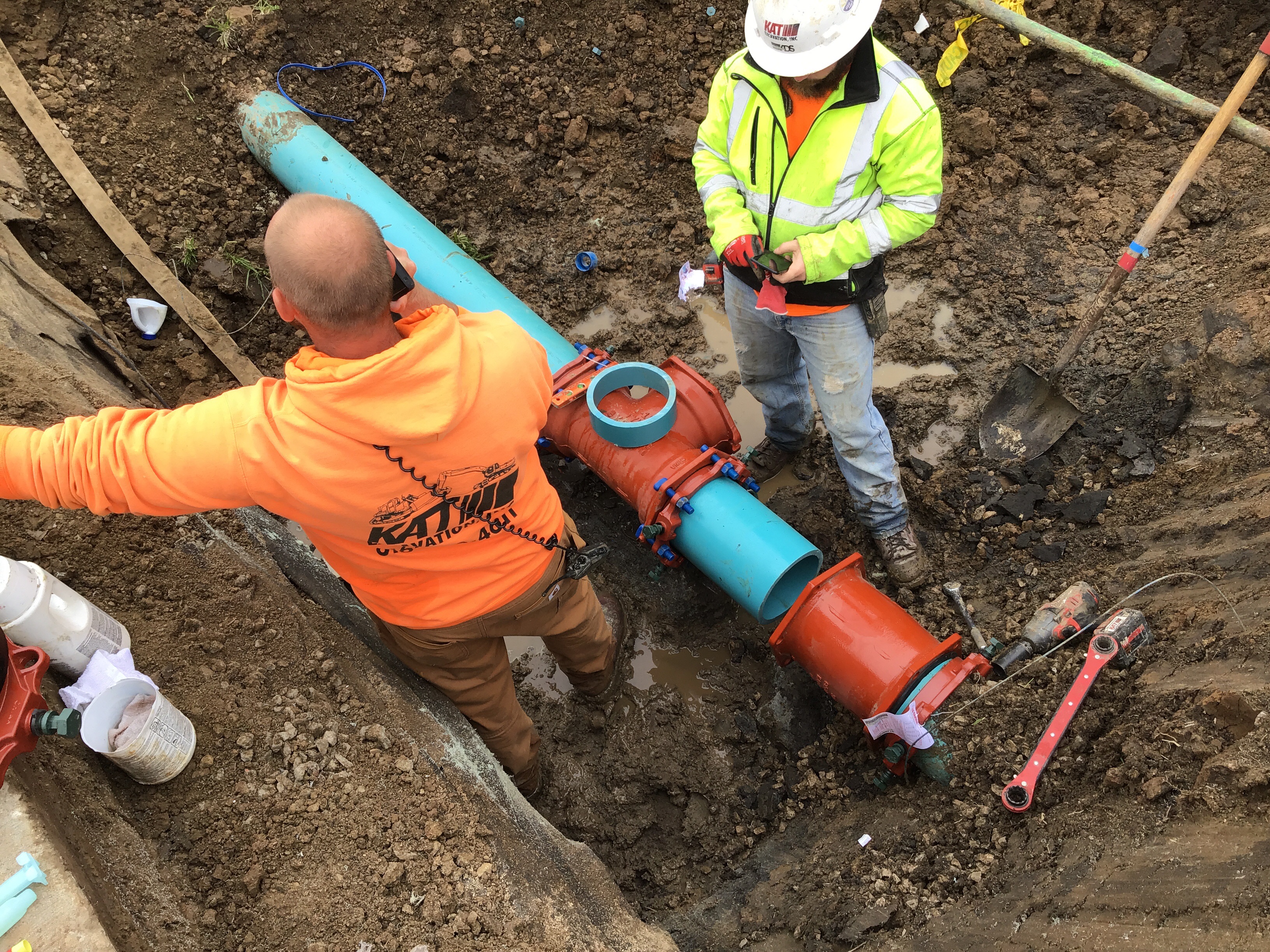

Contractor (Kat Construction) installed an 8” sleeve & 8”X8” tee tie in for the fire line and a 8” valve. All fittings and pipes up to 8” valve were swab with chlorine. All ductile fittings were wrapped in plastic. Contractor poured backing block. Line was flushed placed back in service.
Fire Line Construction Inspection Passed 09/22/2020
Misc
Informational
05/13/2020
Contractor (Kat Construction) installed an 8” sleeve & 8”X8” tee tie in for the fire line and a 8” valve. All fittings and pipes up to 8” valve were swab with chlorine. All ductile fittings were wrapped in plastic. Contractor poured backing block.
Hydrant Inspection Passed 09/22/2020
Misc
Informational
05/13/2020
Hydrant was installed on existing 8” water main near 2641 NE Mc Baine Dr as per project plans.8” sleeve and 8”x6” tee was installed on existing water main. Water was main was flushed and restoredto normal operation. Hydrant will need an extension to bring it to final grade.
Hydrant Inspection Passed 09/22/2020
Misc
Informational
05/13/2020
Hydrant was installed on existing 8” water main near 2641 NE Mc Baine Dr as per project plans.8” sleeve and 8”x6” tee was installed on existing water main. Water was main was flushed and restoredto normal operation. Hydrant will need an extension to bring it to final grade.
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/18/2020
Contractor began to install storm line 1 starting at existing junction box.
Misc
Informational
05/18/2020
Contractor installed approximately 70 feet of 24”HDPE & 20 feet of 18” HDPE on 5/7/20. On 5/6/20 approximately 118 feet of 24” HDPE. 3/30” Nyoplast curb inlet was installed at Sta. 0+13.32, 1+19.64, & 1+63.49 on storm line #1.
Misc
Informational
05/18/2020
Contractor installed approximately 25’ of 12”HDPE on Storm line #3. Contractor is installing approximately 79’ of 12” HDPE & 62’ of 8” HDPE Storm line #4.
Misc
Informational
05/18/2020
Contractor cored into existing storm line & installed approximately 12” HDPE 148’ of Nyoplast Junction JB-2-1, JB-2-3 & Nyoplast Curb Inlet A1-2-2.
Misc
Informational
05/19/2020
Storm line #2 was completed 75’ of 12” HDPE. Storm line #4 was completed 5/18/20 78’ of 12 HDPE 12” & 62’ of 8” HDPE.
Storm - Pipe Passed 09/22/2020
Misc
Informational
05/19/2020
Contractor began to install storm line 1 starting at existing junction box.
Misc
Informational
05/19/2020
Contractor installed approximately 70 feet of 24”HDPE & 20 feet of 18” HDPE on 5/7/20. On 5/6/20 approximately 118 feet of 24” HDPE. 3/30” Nyoplast curb inlet was installed at Sta. 0+13.32, 1+19.64, & 1+63.49 on storm line #1.
Misc
Informational
05/19/2020
Contractor installed approximately 25’ of 12”HDPE on Storm line #3. Contractor is installing approximately 79’ of 12” HDPE & 62’ of 8” HDPE Storm line #4.
Misc
Informational
05/19/2020
Contractor cored into existing storm line & installed approximately 12” HDPE 148’ of Nyoplast Junction JB-2-1, JB-2-3 & Nyoplast Curb Inlet A1-2-2.
Misc
Informational
05/19/2020
Storm line #2 was completed 75’ of 12” HDPE. Storm line #4 was completed 5/18/20 78’ of 12 HDPE 12” & 62’ of 8” HDPE.
Roof Drain Passed 09/22/2020
Misc
Informational
05/19/2020
Roof drains down spouts and below ground lines were completed 5/19/20 as per plan.
Roof Drain Passed 09/22/2020
Misc
Informational
05/19/2020
Roof drains down spouts and below ground lines were completed 5/19/20 as per plan.
Water Line - Coliform Test 2 Passed 09/22/2020
Misc
Informational
06/10/2020
Coliform sample was taken waiting for results. 6/10/20 Wednesday
Curb - Proof Roll Passed 09/22/2020
Misc
Informational
07/20/2020

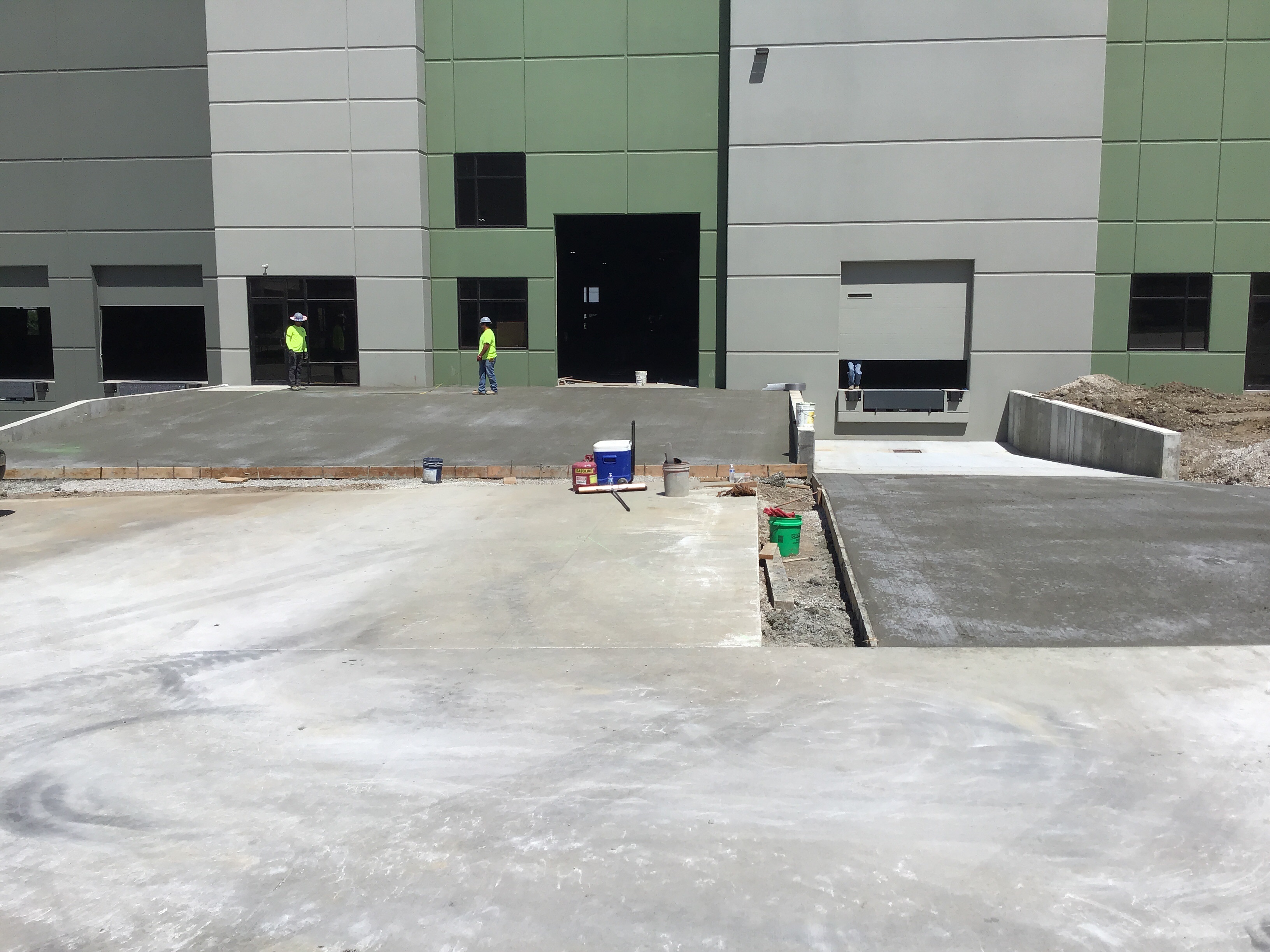

7/20/20 Monday Proof roll passed . Contractor plans to partially install curb on projects site sometime this week.
Driveway Inspection Passed 09/22/2020
Misc
Informational
07/31/2020

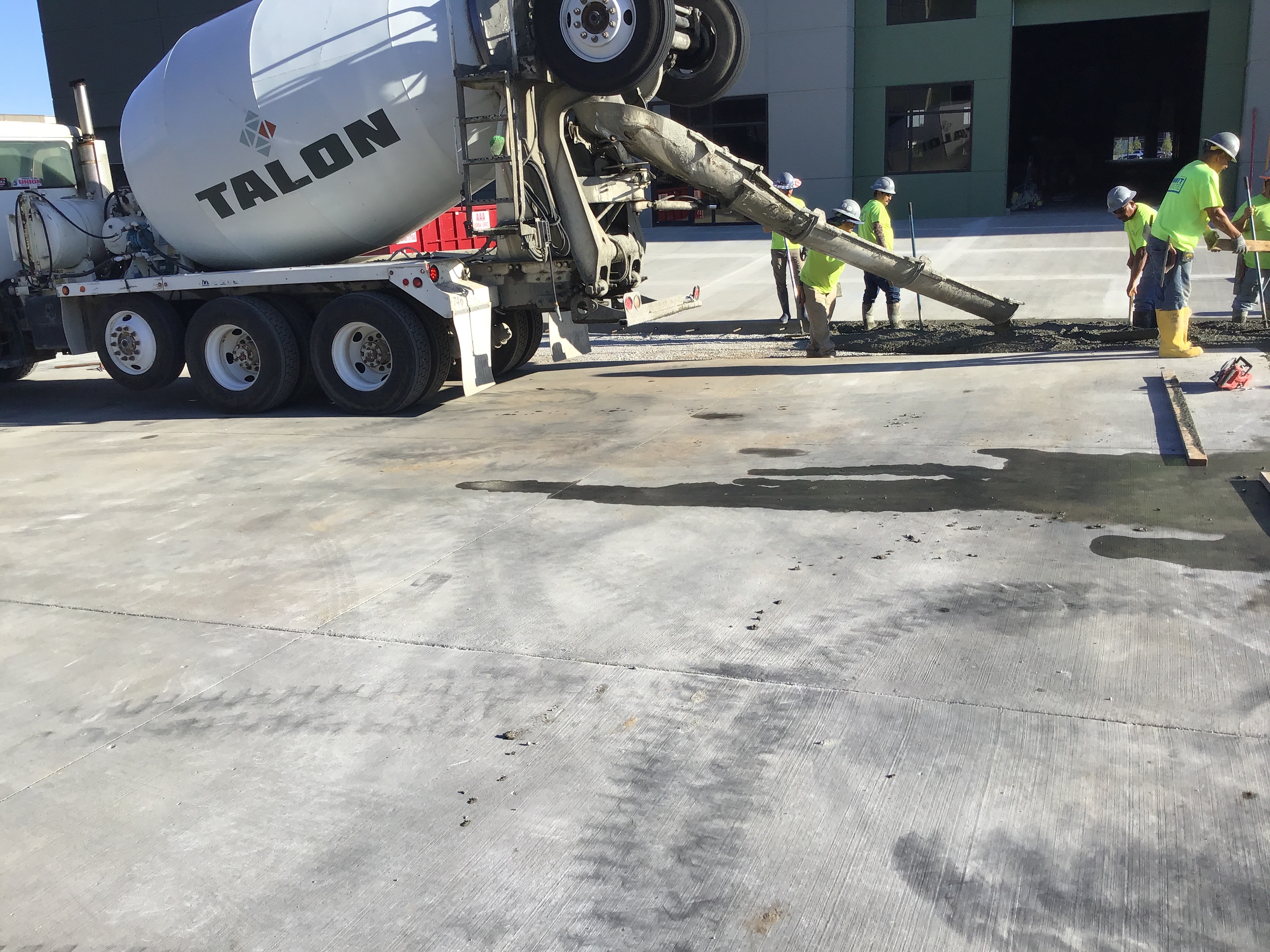

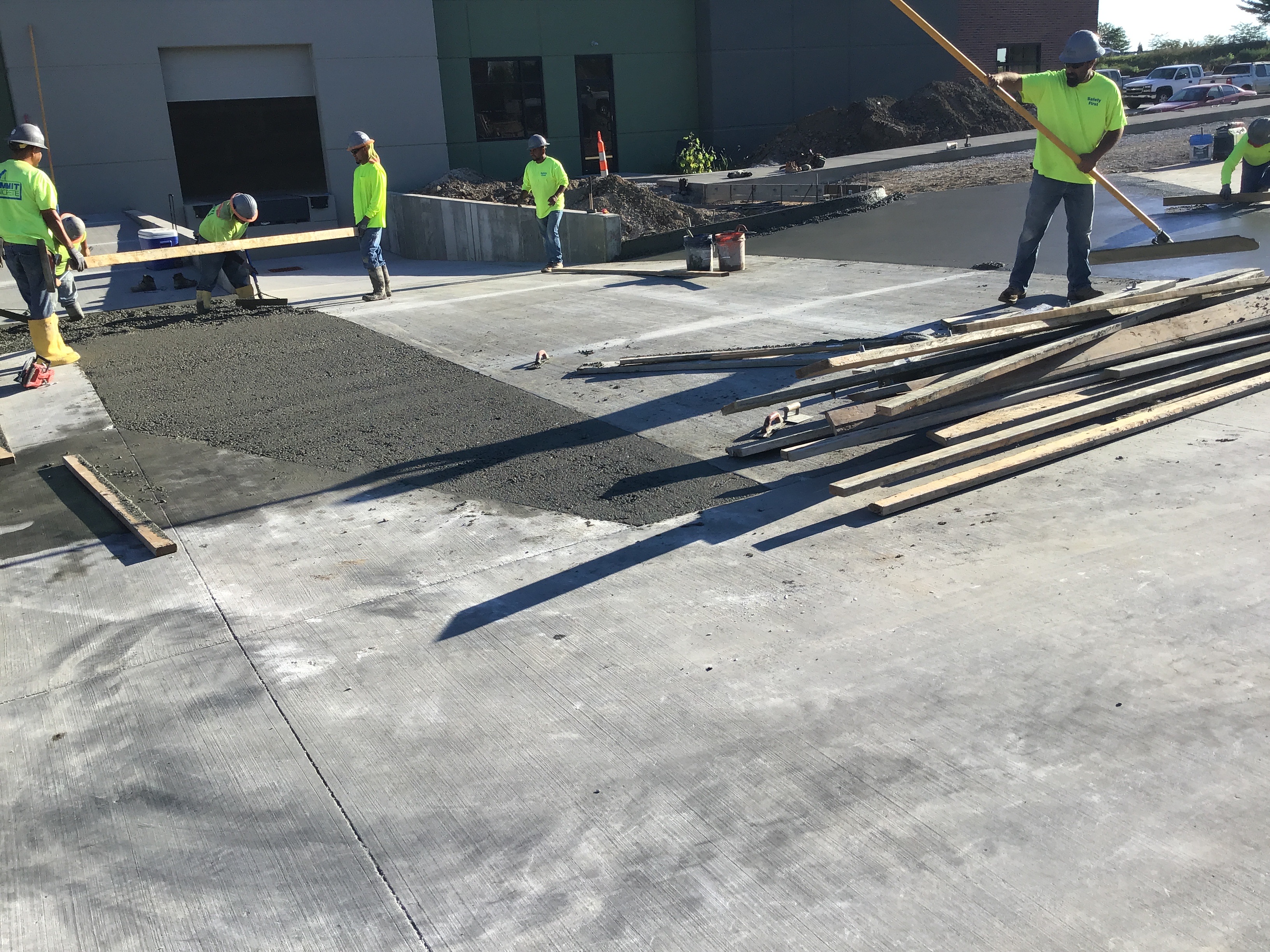

7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/04/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/04/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/04/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/06/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/06/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/06/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/06/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/07/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/07/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/07/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/07/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/07/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/10/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Pavement-Curb Construction Passed 09/22/2020
Misc
Informational
08/07/2020
Contractor cut in ADA curbs for sidewalk crossing for driveway way approach on North entrance from street Mc Baine. Contractor also is removing curb five of curb on the Southwest corner of building project attached to the existing storm box. Structural failure to existing curb made it necessary to replace.
Pavement-Curb Construction Passed 09/22/2020
Misc
Informational
08/07/2020
Contractor cut in ADA curbs for sidewalk crossing for driveway way approach on North entrance from street Mc Baine. Contractor also is removing curb five of curb on the Southwest corner of building project attached to the existing storm box. Structural failure to existing curb made it necessary to replace.
Misc
Informational
08/19/2020
8/19/20 Wednesday Curb and throat of upside leading to existing storm box was replaced.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/10/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/10/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/10/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/10/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/10/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Misc
Informational
08/11/2020
8/18/20 Tuesday 12:41PM Contractor pouring concrete for the dock are on the south end of building.
Sidewalk Inspection Passed 09/22/2020
Misc
Informational
08/19/2020
Contractor poured sidewalk and stairs to the South and East end of building.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/18/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/18/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/18/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/18/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/18/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Misc
Informational
08/18/2020
8/18/20 Tuesday 12:41PM Contractor pouring concrete for the dock are on the south end of building.
Misc
Informational
08/20/2020
8/20/20 Thursday 8:26AM Contractor pouring concrete again on the dock on the south end of building.
Sidewalk Inspection Passed 09/22/2020
Misc
Informational
08/19/2020
Contractor poured sidewalk and stairs to the South and East end of building.
Misc
Informational
08/26/2020
8/26/20 12:00PM Contractor has been working on forms and materials since yesterday. Contractor began pouring concrete for sidewalk around 11;00AM today. Pre-inspection was perform on sidewalk forms & materials it met requirements to pour concrete.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/20/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/20/2020

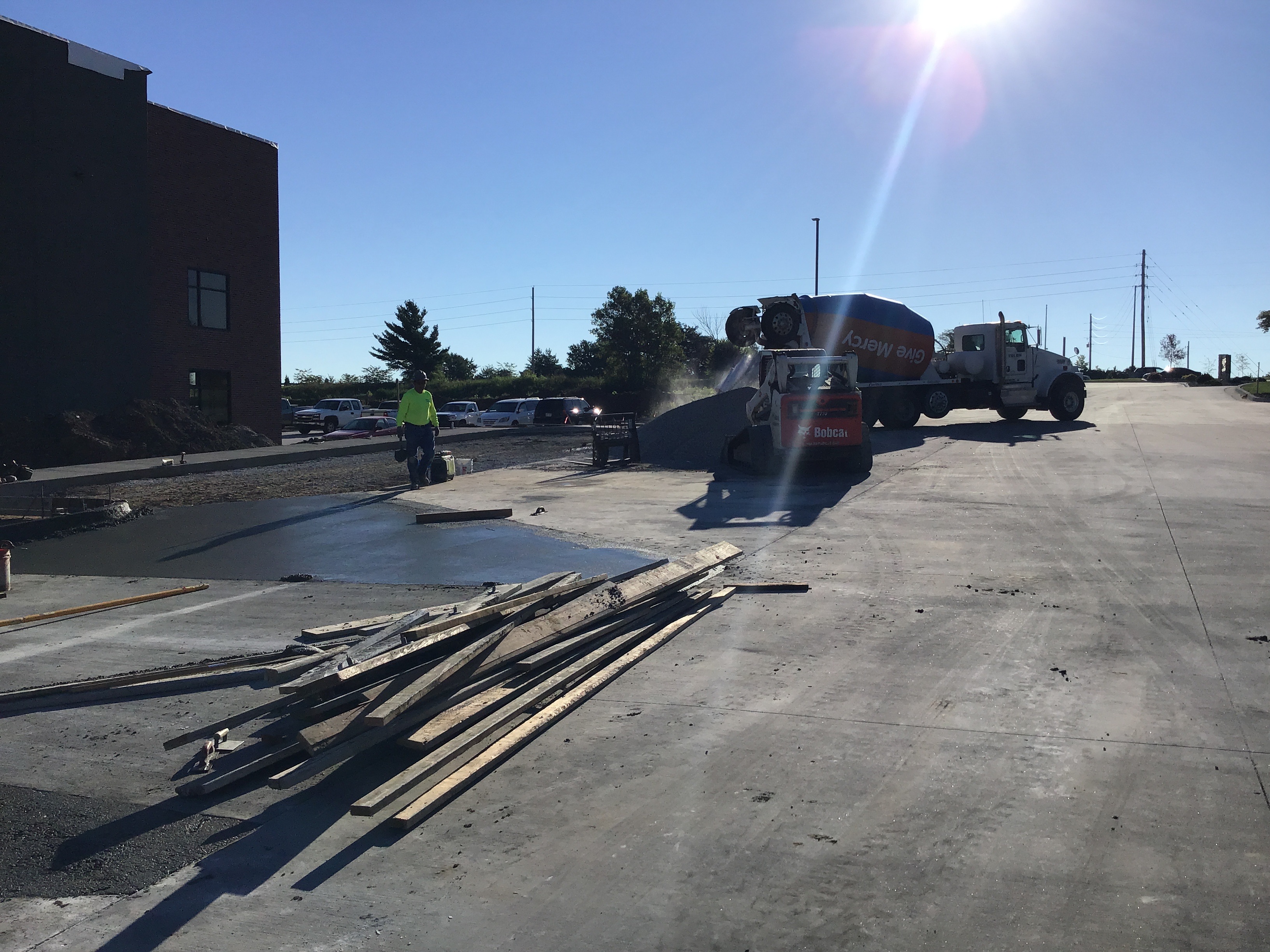

8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/20/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/20/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/20/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Misc
Informational
08/20/2020
8/18/20 Tuesday 12:41PM Contractor pouring concrete for the dock are on the south end of building.
Misc
Informational
08/20/2020
8/20/20 Thursday 8:26AM Contractor pouring concrete again on the dock on the south end of building.
Misc
Informational
08/21/2020
8/21/20 Friday 7:45AM Met with contractor about pouring the approach on the Northeast entrance of the project. Contractor will pour approach on 8/24/20 Monday morning. Contractor has move back to complete concrete pour of driveway on the North end of building. I will take picture and add them to file as work is being done.
Driveway Inspection Passed 09/22/2020
Misc
Informational
08/21/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/21/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/21/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/21/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/21/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Misc
Informational
08/21/2020
8/18/20 Tuesday 12:41PM Contractor pouring concrete for the dock are on the south end of building.
Misc
Informational
08/21/2020
8/20/20 Thursday 8:26AM Contractor pouring concrete again on the dock on the south end of building.
Misc
Informational
08/21/2020
8/21/20 Friday 7:45AM Met with contractor about pouring the approach on the Northeast entrance of the project. Contractor will pour approach on 8/24/20 Monday morning. Contractor has move back to complete concrete pour of driveway on the North end of building. I will take picture and add them to file as work is being done.
Misc
Informational
08/24/2020
8/24/20 Monday 1:00PM Contractor poured Approach on the NE side of building. See documents for pictures of approach and concrete ticket.
Sidewalk Inspection Passed 09/22/2020
Misc
Informational
08/26/2020
Contractor poured sidewalk and stairs to the South and East end of building.
Misc
Informational
08/26/2020
8/26/20 12:00PM Contractor has been working on forms and materials since yesterday. Contractor began pouring concrete for sidewalk around 11;00AM today. Pre-inspection was perform on sidewalk forms & materials it met requirements to pour concrete.
Misc
Informational
08/27/2020
8/27/20 9:51AM Contractor finished pouring sidewalk and ADA ramp on the Eastside of building as per plans.
Water Line - Coliform Test 1 Passed 09/25/2020
Misc
Informational
06/09/2020
Collected the sample at 10:50 AM 6/9/20 Tuesday.
Water Line - Coliform Test 2 Passed 09/25/2020
Misc
Informational
06/10/2020
Coliform sample was taken waiting for results. 6/10/20 Wednesday
Pavement-Curb Construction Passed 09/25/2020
Misc
Informational
08/19/2020

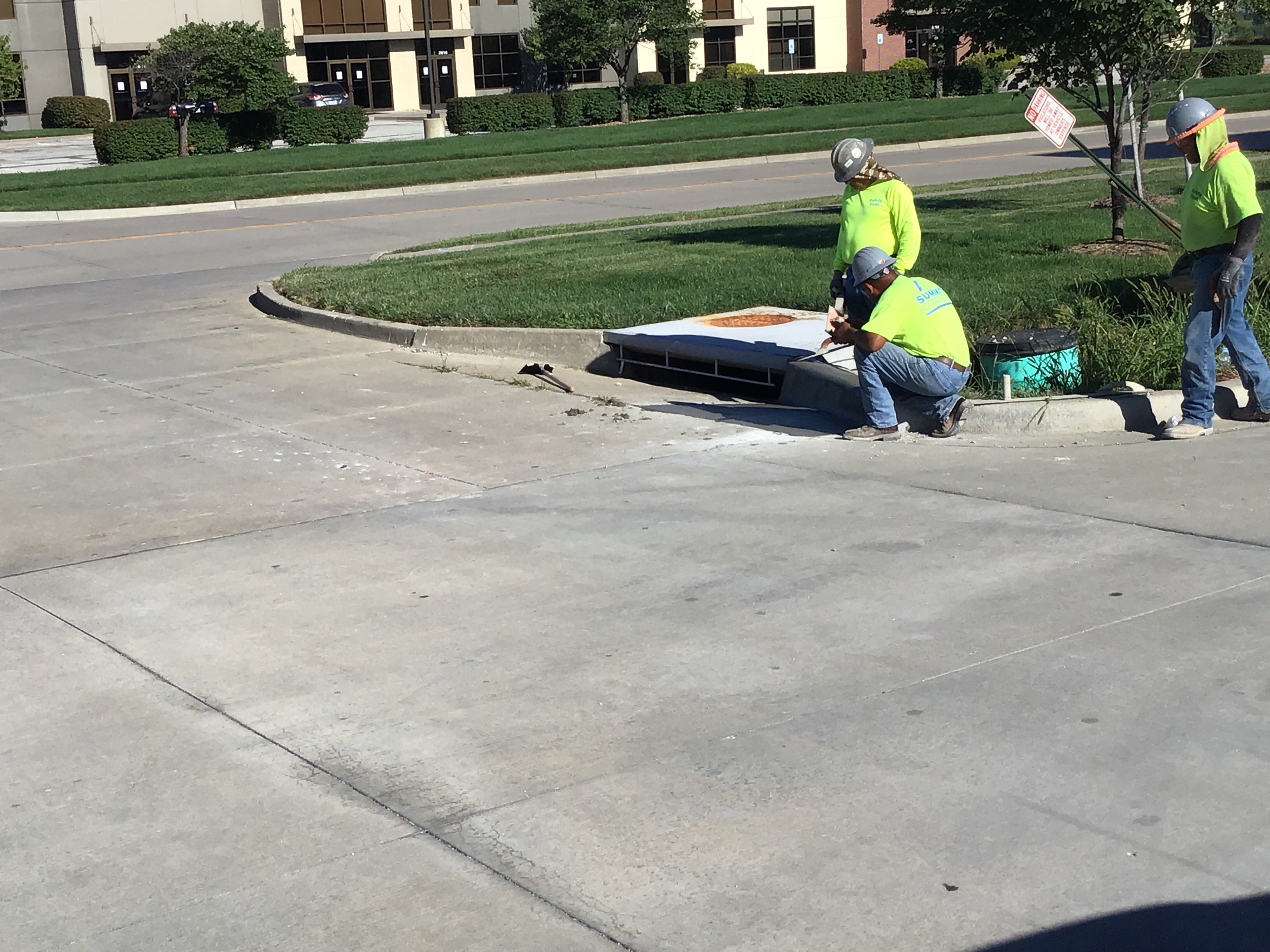

Contractor cut in ADA curbs for sidewalk crossing for driveway way approach on North entrance from street Mc Baine. Contractor also is removing curb five of curb on the Southwest corner of building project attached to the existing storm box. Structural failure to existing curb made it necessary to replace.
Misc
Informational
08/19/2020

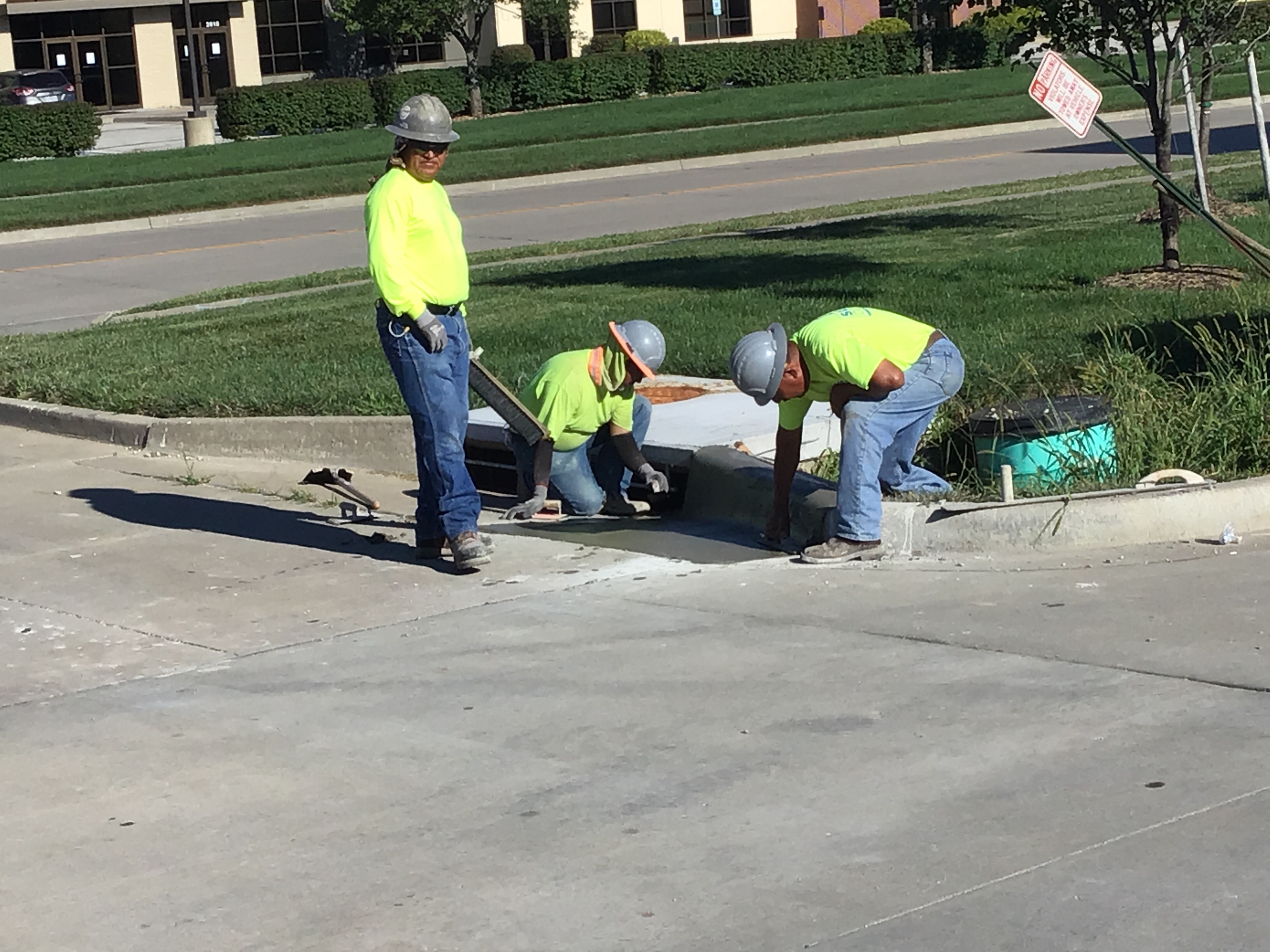

8/19/20 Wednesday Curb and throat of upside leading to existing storm box was replaced.
Driveway Inspection Passed 09/25/2020
Misc
Informational
08/24/2020
7/31/20 Friday Cloudy, Contractor poured partially part of concrete parking lot.
Misc
Informational
08/24/2020
8/4/20 Tuesday Contractor poured concrete for parking lot on the Eastside of building approximately 2/3 of the actual parking area is complete. Contractor work to prepare the last 1/3 of parking space area for concrete pour.
Misc
Informational
08/24/2020
8/5/20 Wednesday Contractor finished pour the East side of parking lot. Contractor did not pour concrete on 8/6/20 (Cloudy Overcast) but continued to grade parking lot for future concrete work.
Misc
Informational
08/24/2020
Contractor poured concrete the driveway entrance on the Eastside of building for the South and North entrances. The Dock concrete pads are being poured on the South end of the building.
Misc
Informational
08/24/2020
8/10/20 Monday Contractor continued to pour concrete driveway and dock area on the Northside of the building.
Misc
Informational
08/24/2020
8/18/20 Tuesday 12:41PM Contractor pouring concrete for the dock are on the south end of building.
Misc
Informational
08/24/2020
8/20/20 Thursday 8:26AM Contractor pouring concrete again on the dock on the south end of building.
Misc
Informational
08/24/2020
8/21/20 Friday 7:45AM Met with contractor about pouring the approach on the Northeast entrance of the project. Contractor will pour approach on 8/24/20 Monday morning. Contractor has move back to complete concrete pour of driveway on the North end of building. I will take picture and add them to file as work is being done.
Misc
Informational
08/24/2020
8/24/20 Monday 1:00PM Contractor poured Approach on the NE side of building. See documents for pictures of approach and concrete ticket.
Sidewalk Inspection Passed 09/25/2020
Misc
Informational
08/27/2020
Contractor poured sidewalk and stairs to the South and East end of building.
Misc
Informational
08/27/2020
8/26/20 12:00PM Contractor has been working on forms and materials since yesterday. Contractor began pouring concrete for sidewalk around 11;00AM today. Pre-inspection was perform on sidewalk forms & materials it met requirements to pour concrete.
Misc
Informational
08/27/2020
8/27/20 9:51AM Contractor finished pouring sidewalk and ADA ramp on the Eastside of building as per plans.
Storm - Swales Passed 09/25/2020
Documents & Images
Date Uploaded File Type Document Name
09/05/2019 Receipt Receipt for transaction: 2019-006061
09/10/2019 Letter DE-Permit
09/16/2019 Sign Permit
10/14/2019 Letter DE-Daily Inspection Summary
05/04/2020 Receipt Receipt for transaction: 2020-001881
05/06/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter DE-Daily Inspection Summary
05/06/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY

05/13/2020 image 8”x8” tee tie-in
05/13/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/18/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
06/05/2020 Letter INSPECTION SUMMARY
06/05/2020 Letter INSPECTION SUMMARY
06/10/2020 Letter INSPECTION SUMMARY
06/10/2020 Letter INSPECTION SUMMARY
07/06/2020 Letter INSPECTION SUMMARY
07/08/2020 Letter INSPECTION SUMMARY
07/20/2020 Letter INSPECTION SUMMARY
07/22/2020 image concrete ticket .jpg
07/22/2020 image.jpg
07/22/2020 image.jpg0
07/31/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/06/2020 Letter INSPECTION SUMMARY
08/06/2020 Letter INSPECTION SUMMARY
08/07/2020 Letter INSPECTION SUMMARY
08/07/2020 image.jpg1
08/07/2020 Letter INSPECTION SUMMARY
08/07/2020 Letter INSPECTION SUMMARY
08/10/2020 Letter INSPECTION SUMMARY
08/10/2020 Letter INSPECTION SUMMARY
08/11/2020 image.jpg2
08/18/2020 image.jpg3
08/18/2020 Letter INSPECTION SUMMARY
08/19/2020 Letter INSPECTION SUMMARY
08/19/2020 image.jpg4
08/19/2020 image.jpg5
08/19/2020 Letter INSPECTION SUMMARY
08/19/2020 Letter INSPECTION SUMMARY
08/20/2020 image.jpg6
08/20/2020 image.jpg7
08/20/2020 image.jpg8
08/20/2020 image.jpg9
08/20/2020 Letter INSPECTION SUMMARY
08/21/2020 Letter INSPECTION SUMMARY
08/24/2020 image.jpg10
08/24/2020 image.jpg11
08/24/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
08/26/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
09/25/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
09/25/2020 Letter DE-Punch List
09/25/2020 I-470 Business and Technology Center, Lots 13A Substantial Completion
09/25/2020 I-470 Business and Technology Center, Lots 13A Punch List
10/22/2020 Receipt Receipt for transaction: 2020-007102
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
12/03/2020 Letter INSPECTION SUMMARY
01/26/2021 I-470 Business and Technology Affidavit and Agreement
02/10/2021 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
