Permit Application Status

PRSITE20191837

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSITE20191837
Development - Site
Final Acceptance
TUSTIN LLC
DEVELOPMENT COMPLETE
REECE NICHOLS - PUBLIC STREET STORM AND WATER
07/11/2019
07/16/2019
03/17/2023
Locations
Contacts
DAHMER CONTRACTING GROUP LLC, Address:10531 MISSION RD #305
TUSTIN LLC, Address:8375 NIEMAN RD
Reviews

There are no reviews for this permit application.

Fees
Paid Fees Amount Paid Owing Date Paid
91100C9-Water Insp Fee $133.20 $133.20 Paid 07/11/2019
9110072-Water Test Fee $200.00 $200.00 Paid 07/11/2019
9110068-Storm Fee $234.33 $234.33 Paid 07/11/2019
9110081-Paved Surface Inspection Fee $1,841.49 $1,841.49 Paid 07/11/2019
9110073-Right of Way Permit Fee $80.00 $80.00 Paid 07/11/2019
9110069-After Hours Inspections (Public Works)(Per Hour) $725.00 $725.00 Paid 11/20/2020
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Water - Material Verification Partial 7/30/2019 07/30/2019
Misc
Informational
07/30/2019

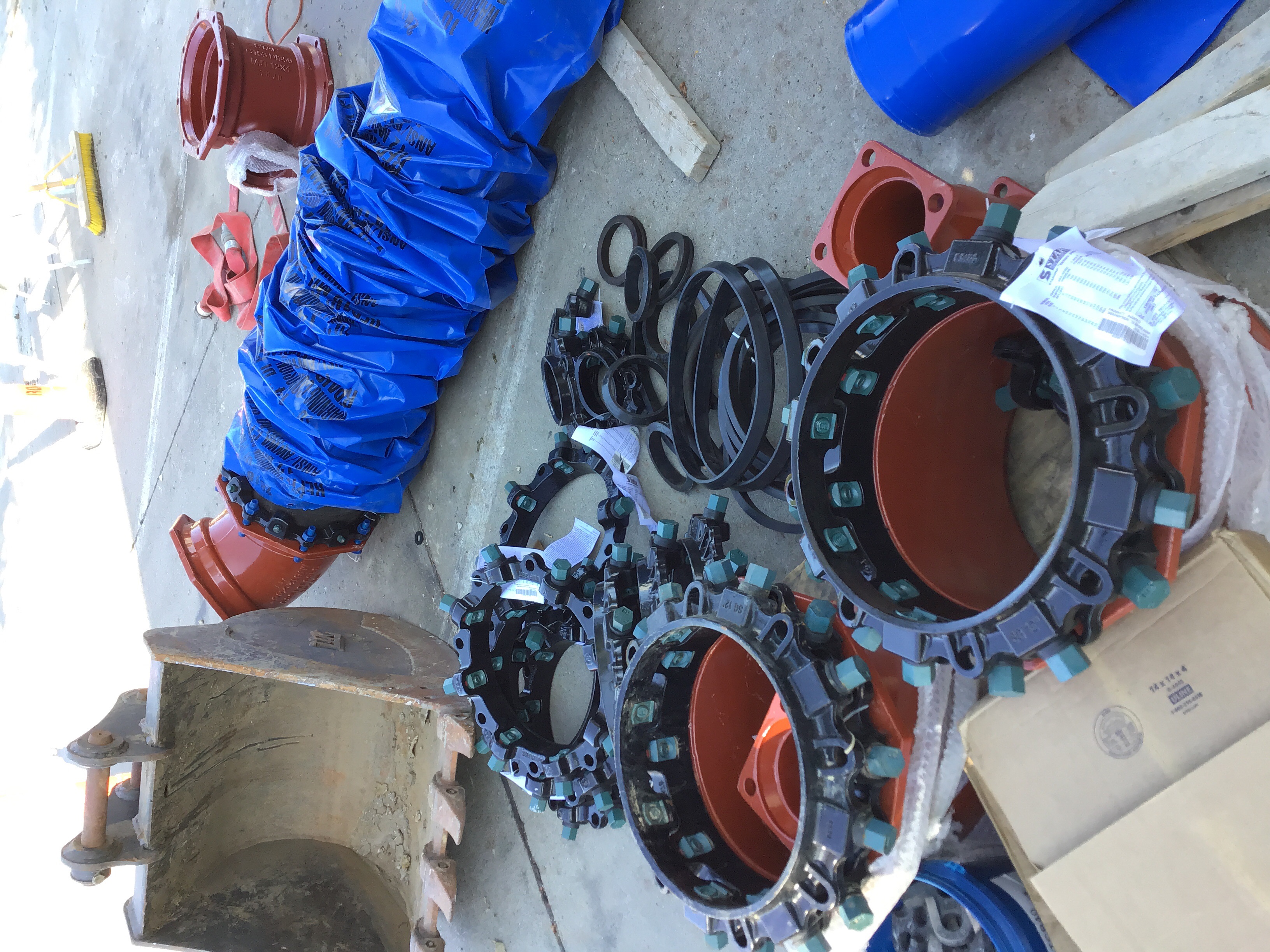

7-30-19 All material appears to be correct for the job.
Water Line - Construction Inspection Partial 7/30/2019 08/01/2019
Misc
Informational
07/30/2019

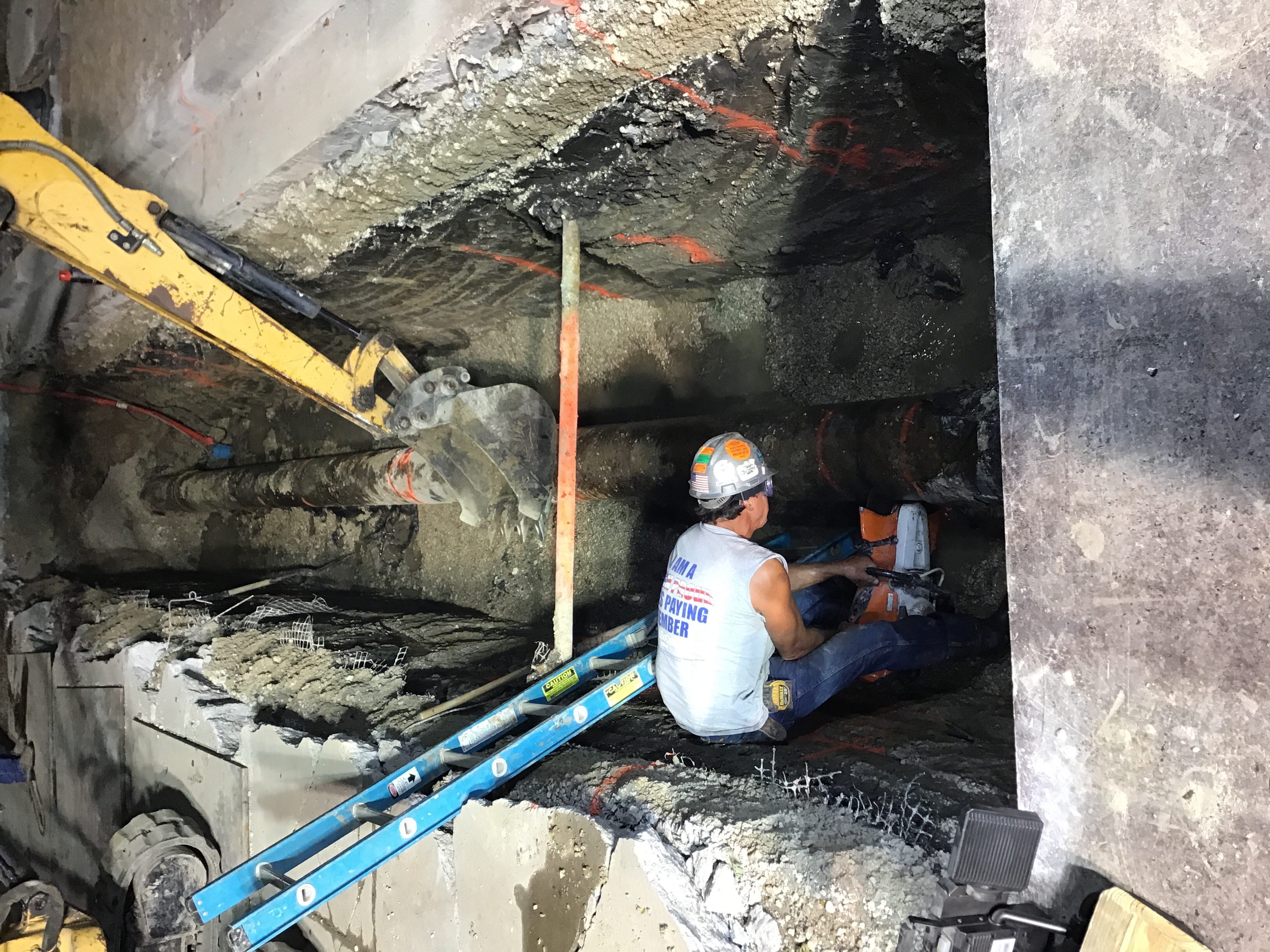

7-30-19 The crew had some issues with digging around electrical wire. We did not get the water shut off till just after 8:00pm. 8:40pm They have cut into the water main and are draining it. The fireline was completed at approximately 12:30am. 1:40am They are digging for the new water main line and placing concrete blocks for restraint. 6:00am They are now placing the new water main. 8:00am Steve Robbins is taking over for me.
Water Line - Thrust Restraint Partial 7/31/2019 08/05/2019
Misc
Informational
08/05/2019
7-5-19 They have poured the thrust restraints for the main.

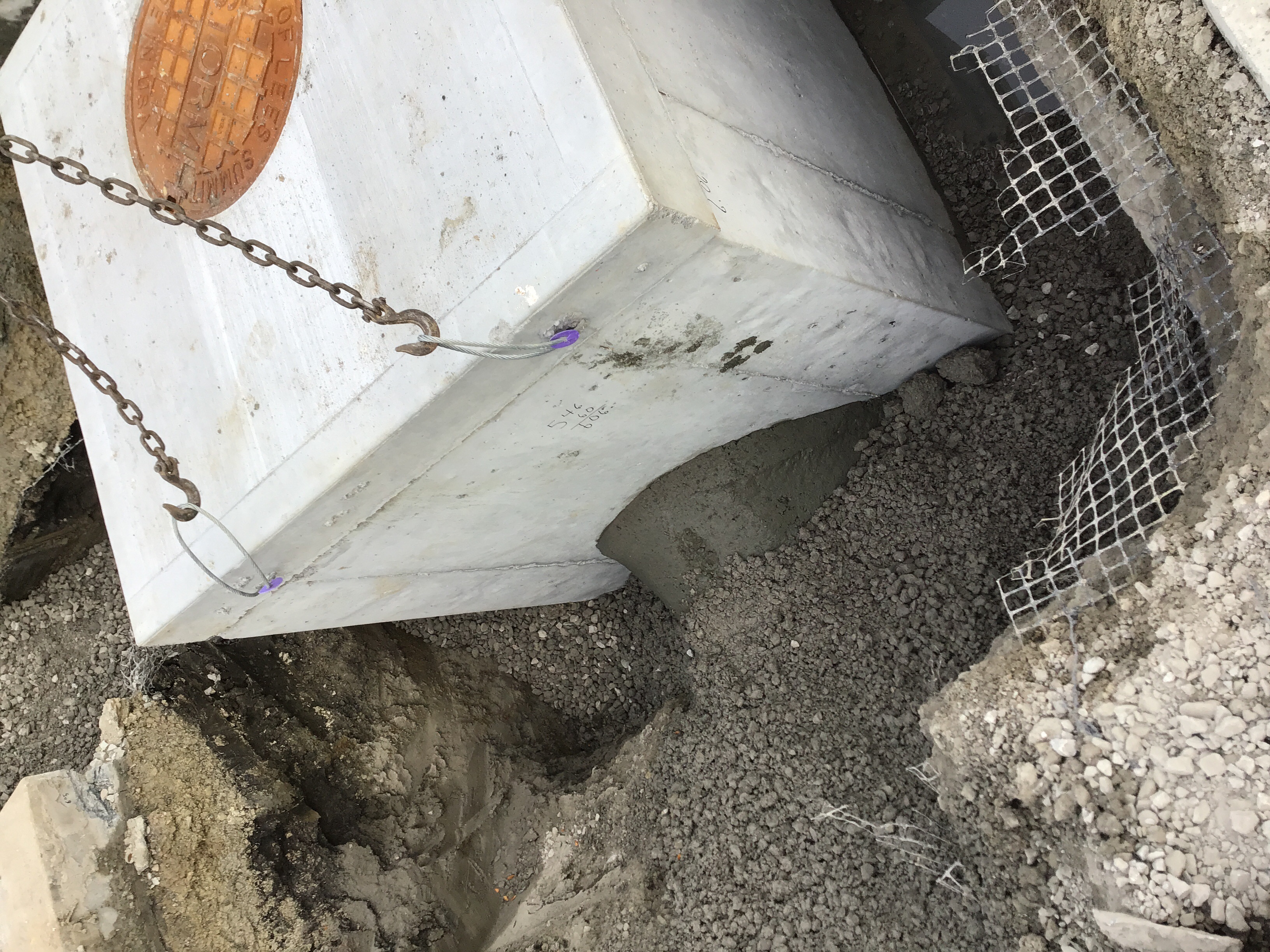

Storm - Pipe Partial 8/12/2019 08/12/2019
Misc
Informational
08/12/2019

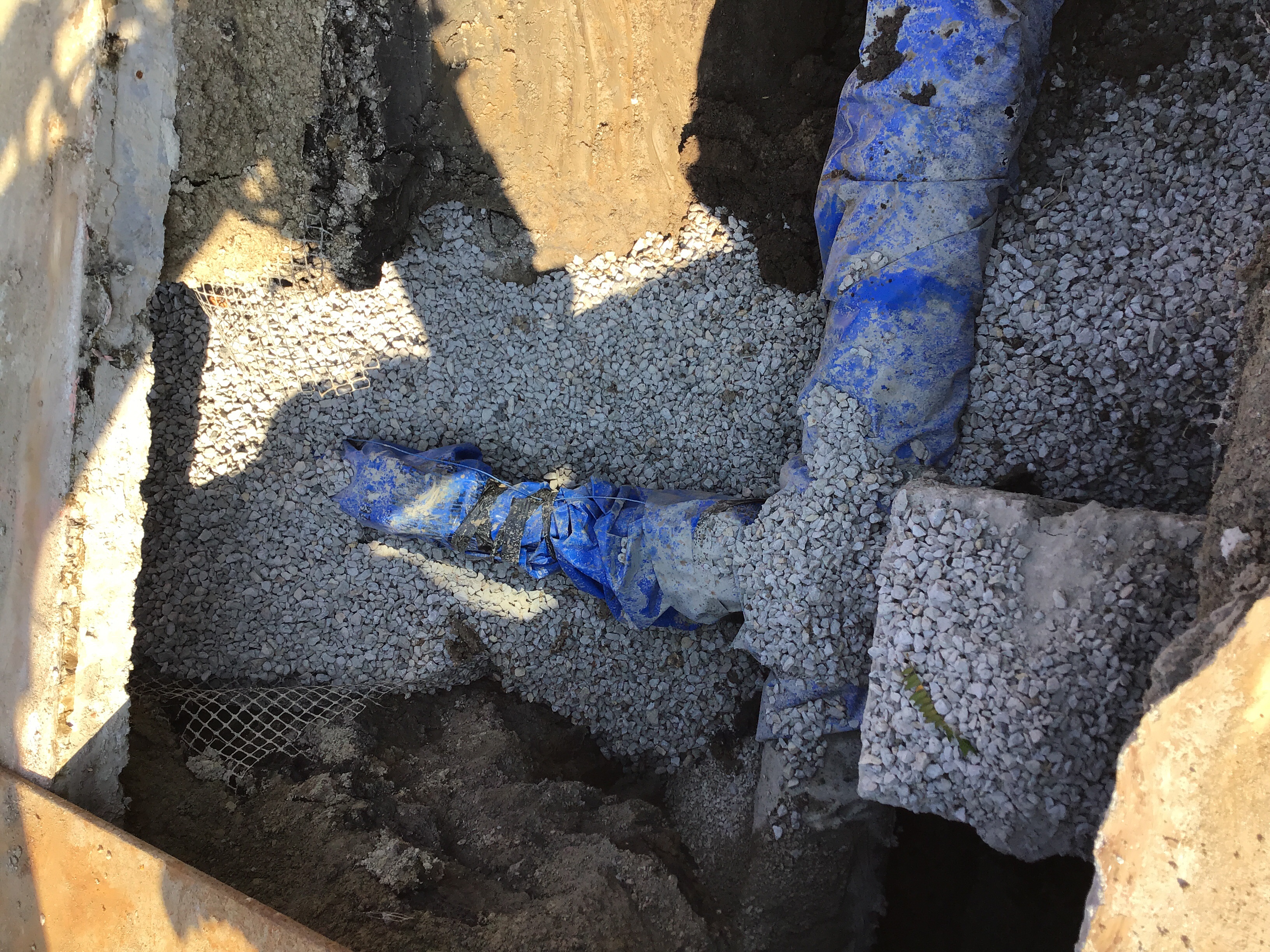

8-12-19 The storm pipe has been ran along the west side of the site.
Storm - Pipe Partial 8/13/2019 08/13/2019
Misc
Informational
08/12/2019
8-12-19 The storm pipe has been ran along the west side of the site.
Misc
Informational
08/13/2019
8-13-19 The have installed 30 feet of storm on the east side heading into the street. They are backfilling in lifts and have compacted base.
Storm - Pipe Partial 8/14/2019 08/14/2019
Misc
Informational
08/13/2019
8-12-19 The storm pipe has been ran along the west side of the site.
Misc
Informational
08/13/2019
8-13-19 The have installed 30 feet of storm on the east side heading into the street. They are backfilling in lifts and have compacted base.
Misc
Informational
08/14/2019
8-14-19 10am They are coring the manhole for the storm pipe. 3:00pm They have 60 feet installed and are backfilling.
Storm - Pipe Partial 8/19/2019 08/20/2019
Misc
Informational
08/14/2019
8-12-19 The storm pipe has been ran along the west side of the site.
Misc
Informational
08/14/2019
8-13-19 The have installed 30 feet of storm on the east side heading into the street. They are backfilling in lifts and have compacted base.
Misc
Informational
08/14/2019
8-14-19 10am They are coring the manhole for the storm pipe. 3:00pm They have 60 feet installed and are backfilling.
Misc
Informational
08/15/2019
8-15-19 9:00am They have placed 40 foot of storm pipe and are backfilling before they continue. 1:20pm They have 20 more feet of pipe installed and are digging out for the box.
Misc
Informational
08/19/2019
8-19-19 11:15am They are setting up to place the box in Main st. On the north east side of the site. 3:50pm They have the box installed and will be pouring the collars and invert on Tuesday 8-20-19.
Storm - Pipe Partial 8/20/2019 08/20/2019
Misc
Informational
08/20/2019
8-12-19 The storm pipe has been ran along the west side of the site.
Misc
Informational
08/20/2019
8-13-19 The have installed 30 feet of storm on the east side heading into the street. They are backfilling in lifts and have compacted base.
Misc
Informational
08/20/2019
8-14-19 10am They are coring the manhole for the storm pipe. 3:00pm They have 60 feet installed and are backfilling.
Misc
Informational
08/20/2019
8-15-19 9:00am They have placed 40 foot of storm pipe and are backfilling before they continue. 1:20pm They have 20 more feet of pipe installed and are digging out for the box.
Misc
Informational
08/20/2019
8-19-19 11:15am They are setting up to place the box in Main st. On the north east side of the site. 3:50pm They have the box installed and will be pouring the collars and invert on Tuesday 8-20-19.
Misc
Informational
08/20/2019
8-20-19 They have poured the collars and invert for the box and will be backfilling with flowable fill. 9:05am They have backfilled with flowable fill.
Site Visit Partial 8/21/2019 08/21/2019
Misc
Informational
08/21/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Site Visit Partial 08/23/2019
Misc
Informational
08/21/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/23/2019
8-23-19 1:44pm There is no activity at the job site.
Site Visit Partial 8/26/2019 08/27/2019
Misc
Informational
08/23/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/23/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
08/26/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Site Visit Partial 8/27/2019 08/27/2019
Misc
Informational
08/27/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/27/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
08/27/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
08/27/2019
8-27-19 The crew are working on preparing the street for a pour.
Site Visit Partial 8/28/2019 08/28/2019
Misc
Informational
08/27/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/27/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
08/27/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
08/27/2019
8-27-19 The crew are working on preparing the street for a pour.
Misc
Informational
08/28/2019
8-28-19 I spoke with Ed with Quality Cutom Construction about setting up for the pour. They have baskets in place and are preparing to drill for rebar. 3:55pm They are still setting up for the pour. I will inspect it again before they pour.
Street - Surface Course Partial 8/29/2019 08/29/2019
Misc
Informational
08/29/2019

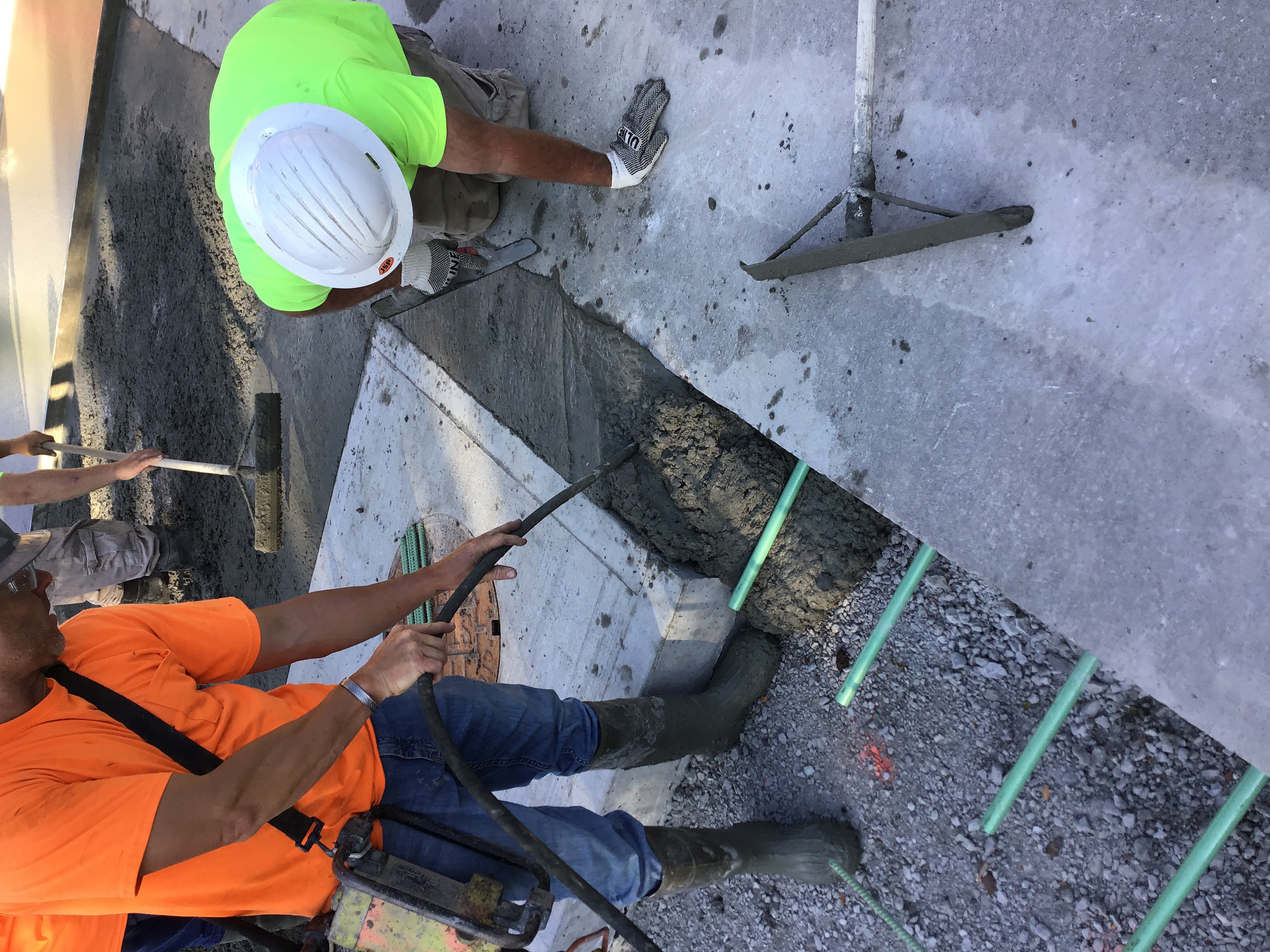

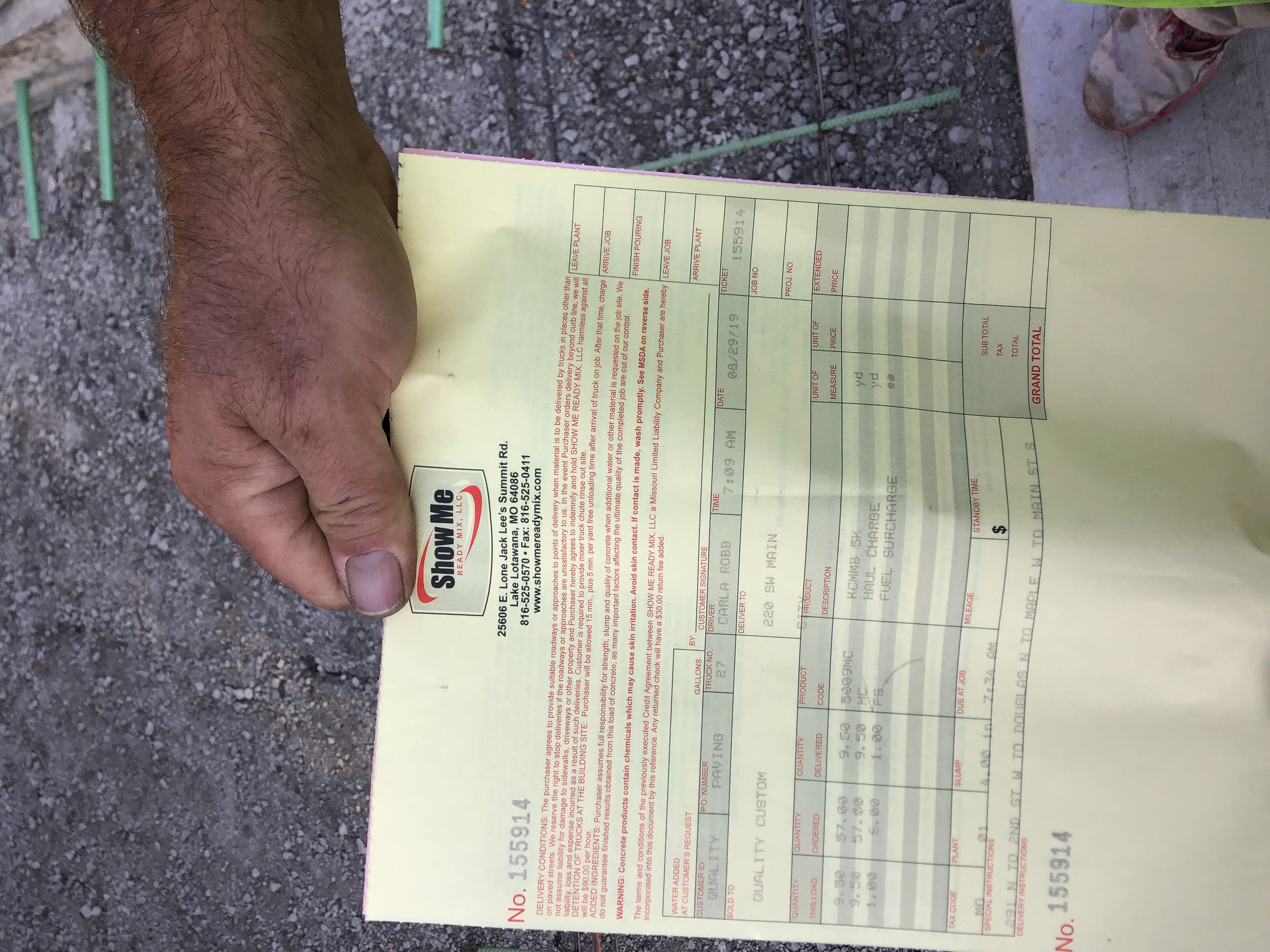

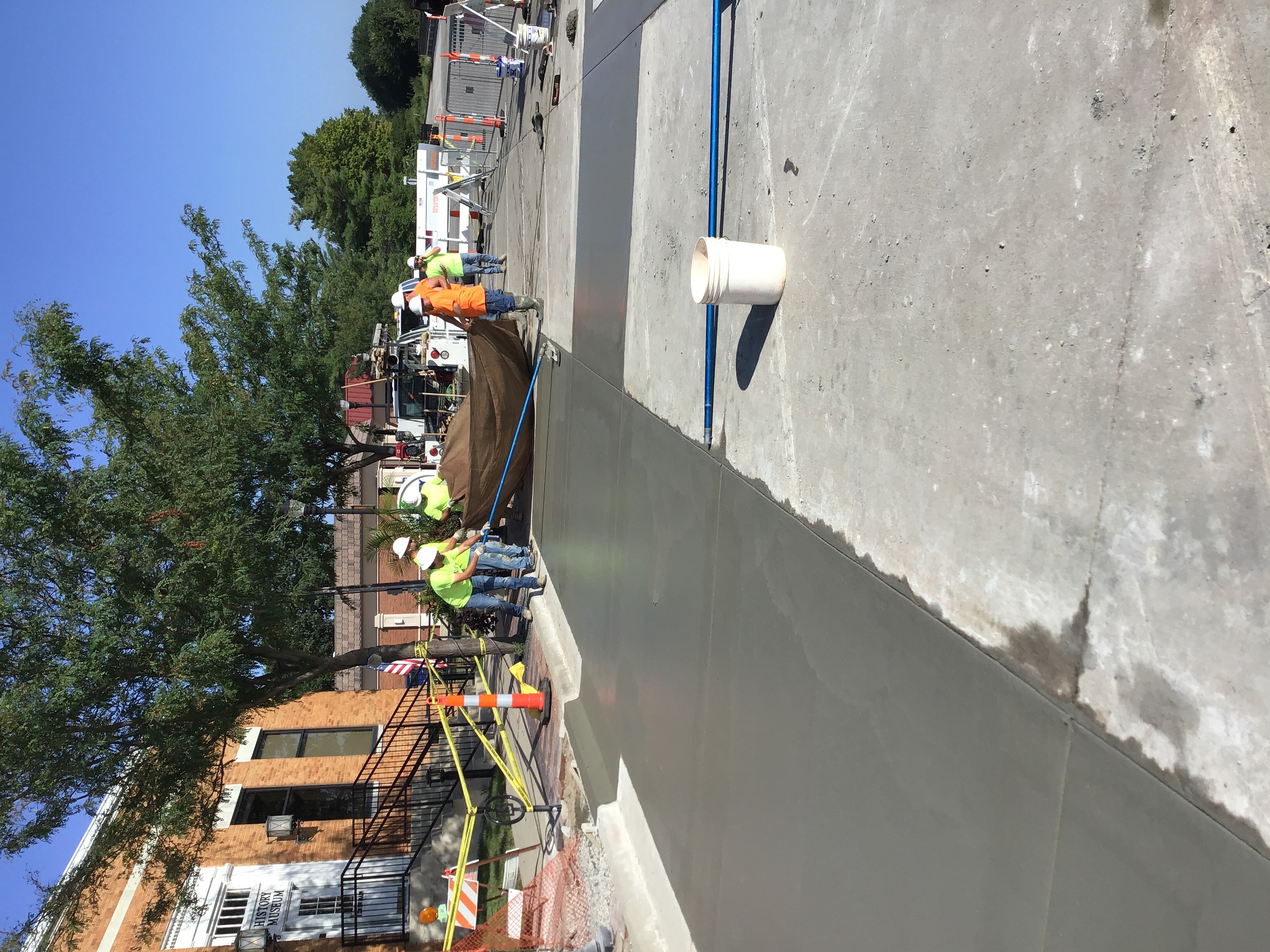

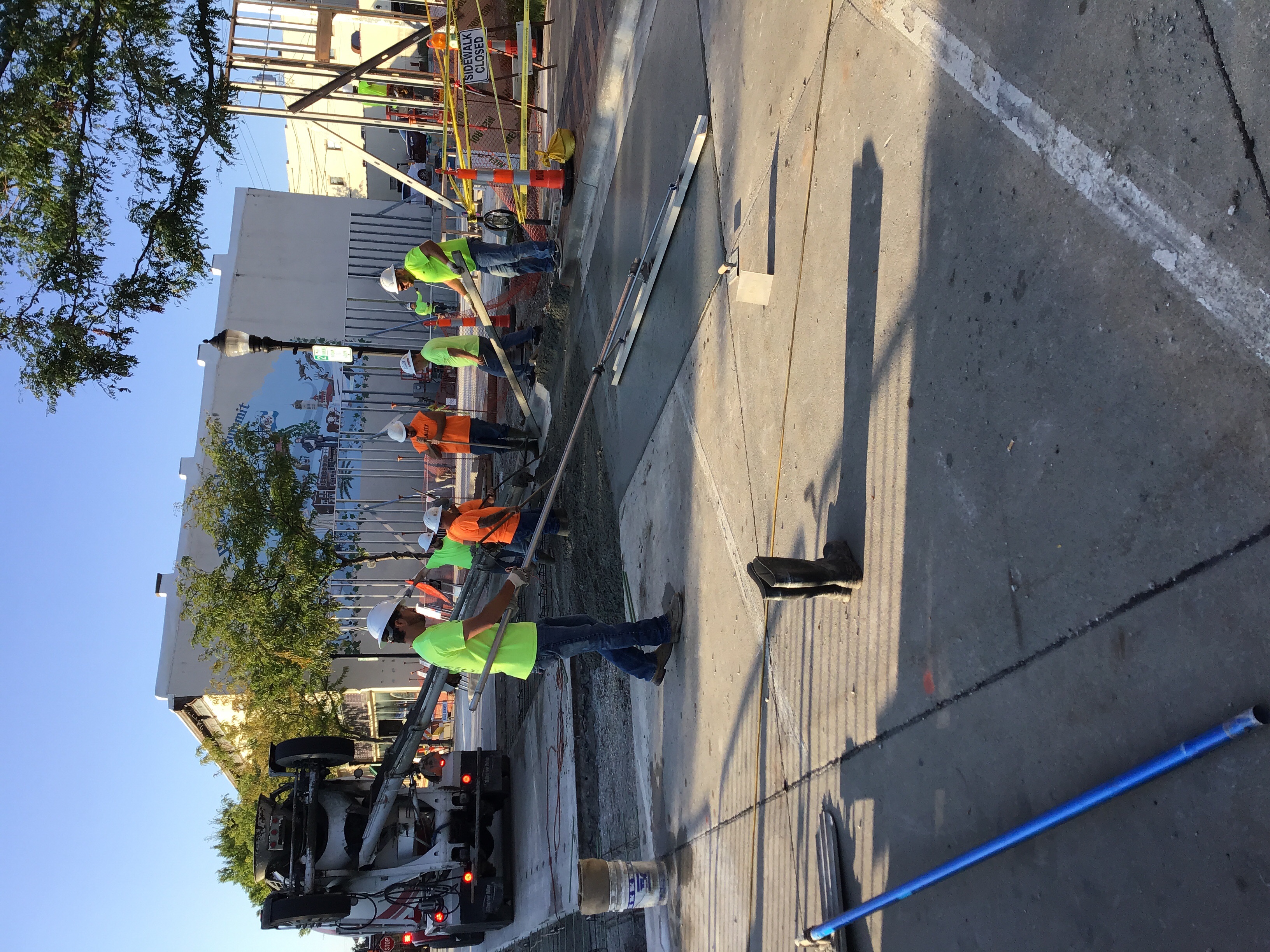

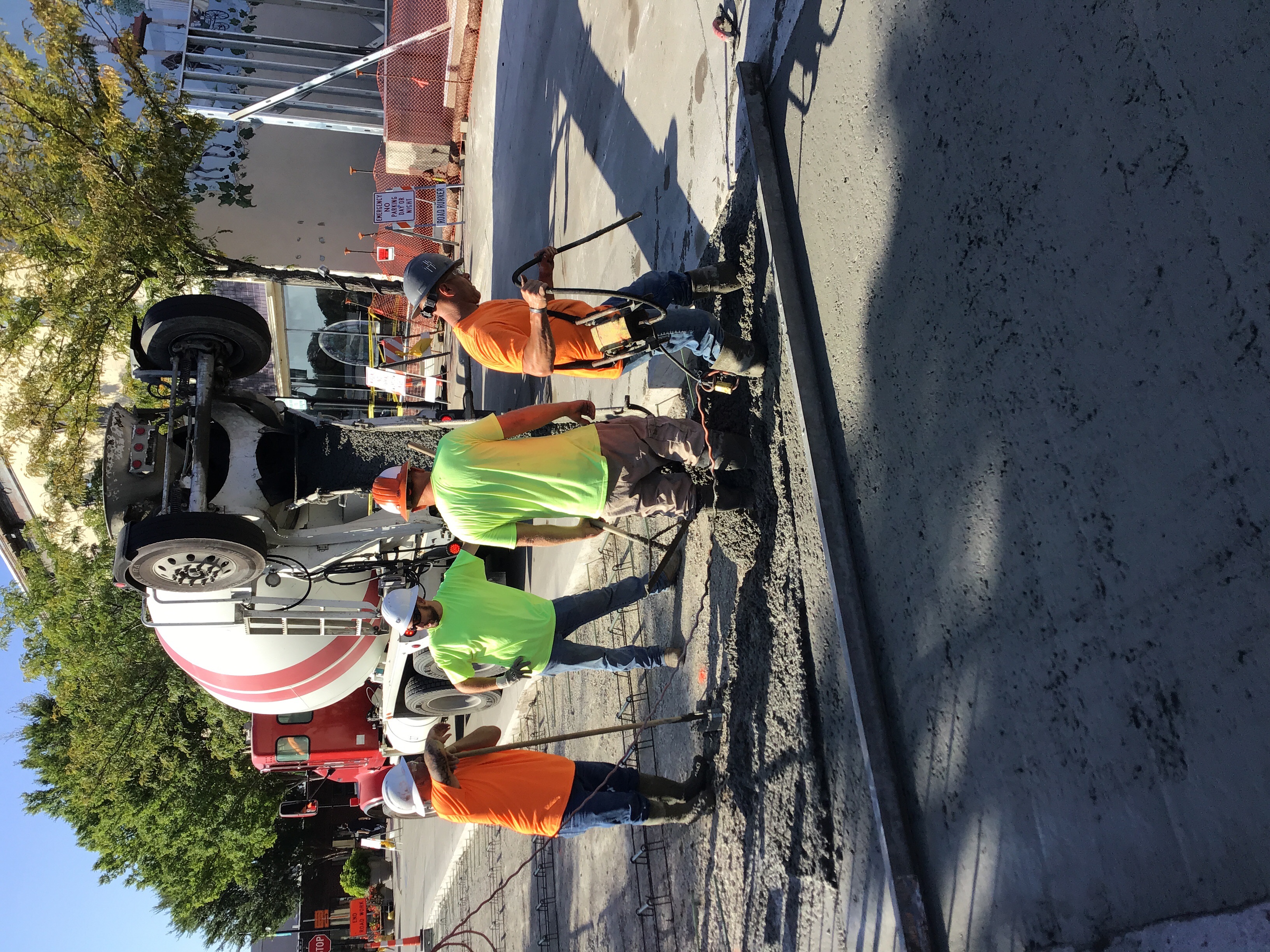

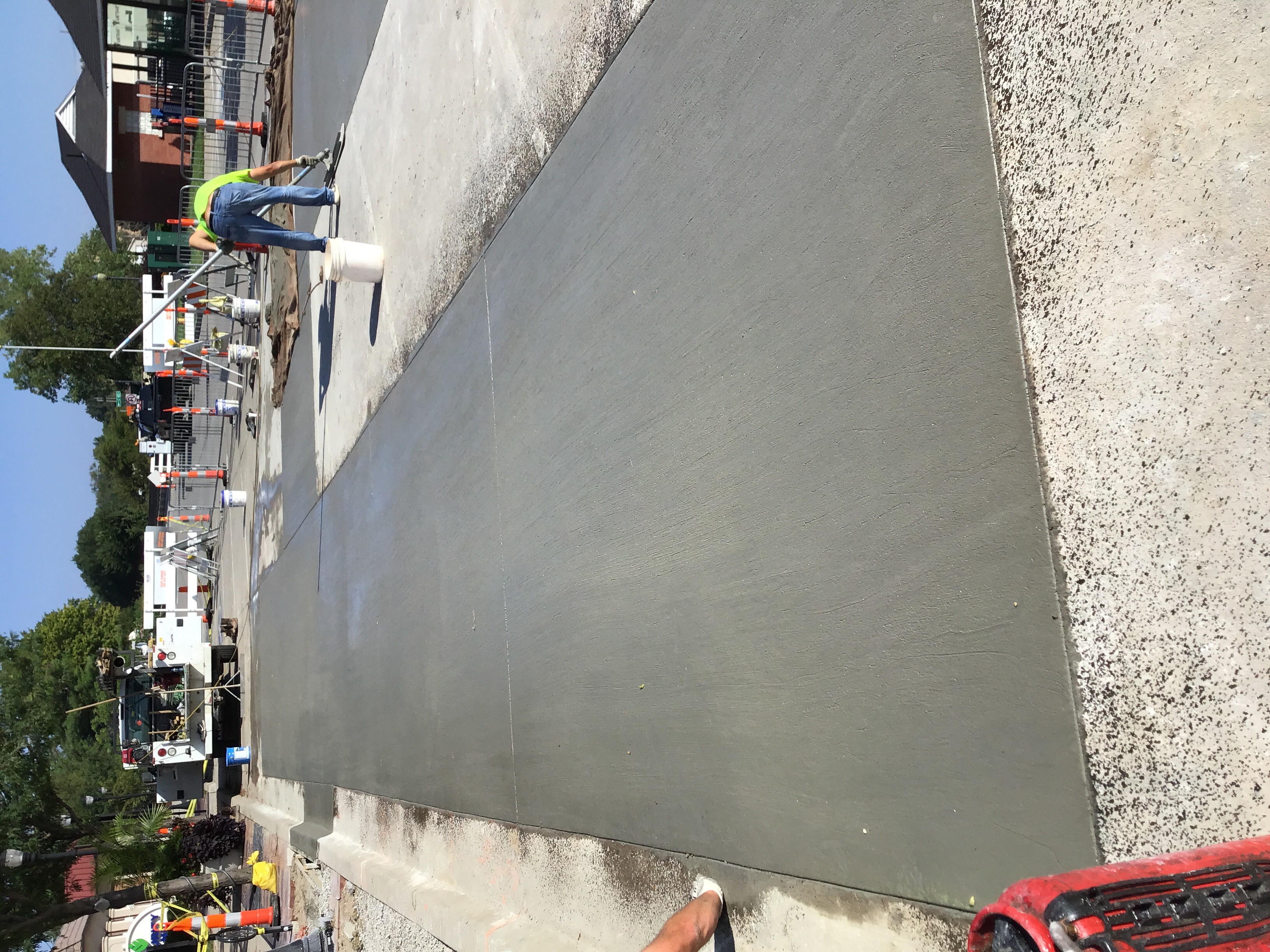

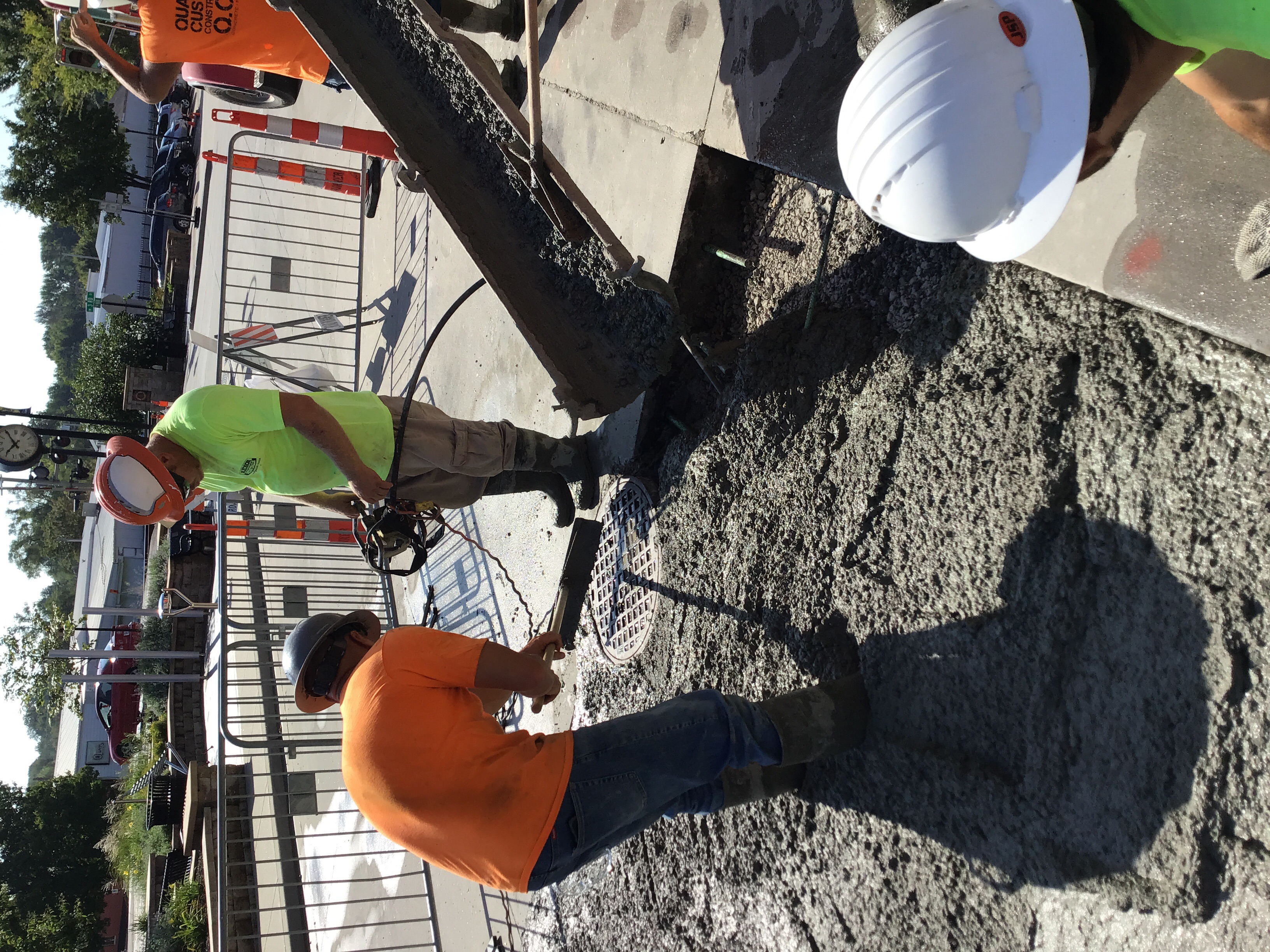

8-29-19 They started pouring at 7:30am. Alpha Omega Geotech is on site to pull samples. Quality Custom Construction did the set up and the pour. They are pouring 5k mix. I have received all concrete tickets for the pour. 10:20am they are done with the pouring and are working on the finish. The last of the cure was applied at 11:00am. They are done and will watch over it for the next two hours.
Site Visit Partial 08/30/2019
Misc
Informational
08/28/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/28/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
08/28/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
08/28/2019
8-27-19 The crew are working on preparing the street for a pour.
Misc
Informational
08/28/2019
8-28-19 I spoke with Ed with Quality Cutom Construction about setting up for the pour. They have baskets in place and are preparing to drill for rebar. 3:55pm They are still setting up for the pour. I will inspect it again before they pour.
Misc
Informational
08/30/2019
8-30-19 approximately 8:30am raining. The contractor was opening parking stalls.
Site Visit Partial 09/04/2019
Misc
Informational
08/30/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
08/30/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
08/30/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
08/30/2019
8-27-19 The crew are working on preparing the street for a pour.
Misc
Informational
08/30/2019
8-28-19 I spoke with Ed with Quality Cutom Construction about setting up for the pour. They have baskets in place and are preparing to drill for rebar. 3:55pm They are still setting up for the pour. I will inspect it again before they pour.
Misc
Informational
08/30/2019
8-30-19 approximately 8:30am raining. The contractor was opening parking stalls.
Misc
Informational
09/04/2019
9-4-19 11:26am Spoke with the contractor about sanitary line issues.
Site Visit Partial 09/18/2019
Misc
Informational
09/04/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
09/04/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
09/04/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
09/04/2019
8-27-19 The crew are working on preparing the street for a pour.
Misc
Informational
09/04/2019
8-28-19 I spoke with Ed with Quality Cutom Construction about setting up for the pour. They have baskets in place and are preparing to drill for rebar. 3:55pm They are still setting up for the pour. I will inspect it again before they pour.
Misc
Informational
09/04/2019
8-30-19 approximately 8:30am raining. The contractor was opening parking stalls.
Misc
Informational
09/04/2019
9-4-19 11:26am Spoke with the contractor about sanitary line issues.
Misc
Informational
09/18/2019
9-18-19 11:25am There is no activity that proteins to me at this time.
Site Visit Partial 9/20/2019 09/20/2019
Misc
Informational
09/18/2019
9-21-19 Talked with contractor about changes needing to be made to the sanitary. 10:10am just finished talking with contractor. I will need to get answers from engineering.
Misc
Informational
09/18/2019
8-23-19 1:44pm There is no activity at the job site.
Misc
Informational
09/18/2019
8-26-19 8:00am They were setting up for the lane closer. They will be preparing the road for a concrete pour this week. They were rained out.
Misc
Informational
09/18/2019
8-27-19 The crew are working on preparing the street for a pour.
Misc
Informational
09/18/2019
8-28-19 I spoke with Ed with Quality Cutom Construction about setting up for the pour. They have baskets in place and are preparing to drill for rebar. 3:55pm They are still setting up for the pour. I will inspect it again before they pour.
Misc
Informational
09/18/2019
8-30-19 approximately 8:30am raining. The contractor was opening parking stalls.
Misc
Informational
09/18/2019
9-4-19 11:26am Spoke with the contractor about sanitary line issues.
Misc
Informational
09/18/2019
9-18-19 11:25am There is no activity that proteins to me at this time.
Misc
Informational
09/20/2019
9-20-19 11:05am There is no activity on site. They have not put the brick pavers back in yet.
Sidewalk Inspection Partial 3/31/2020 03/31/2020
Misc
Informational
03/31/2020

3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20.
Fire Line - Flush Passed 7/30/2019 04/28/2020
Misc
Informational
04/28/2020

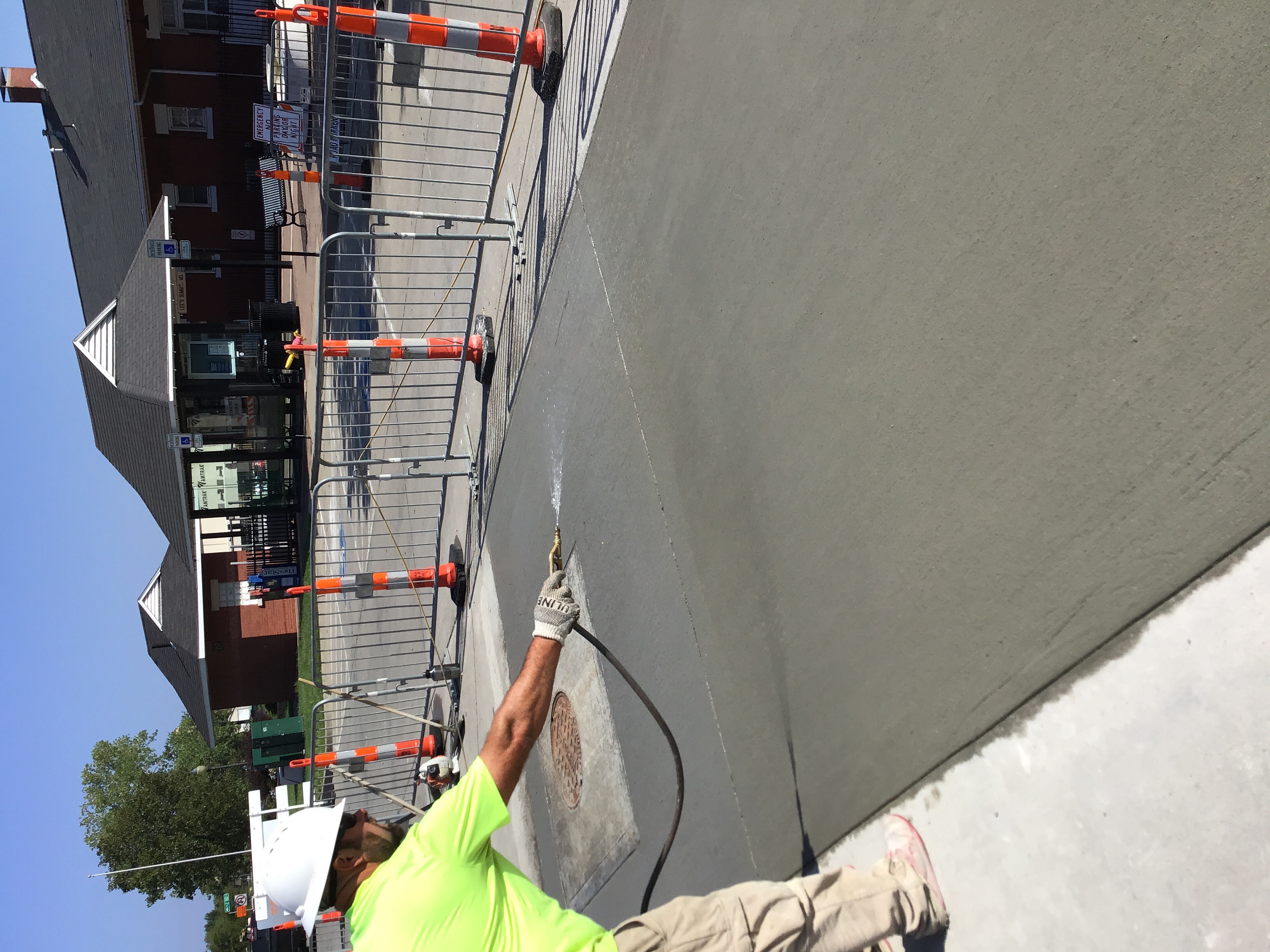

The contractor flushed the fire line after the tie in as we were flushing the main. The fire line and water main was flushed for approxomately 25 minutes.
Sidewalk Inspection Partial 04/29/2020
Misc
Informational
03/31/2020
3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20. 4-29-20 9:33am I met Bob Burns on site with the contractor about how to set up the sidewalk. Bob explain what is expected.
Sidewalk Inspection Partial 04/29/2020
Misc
Informational
04/29/2020
3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20. 4-29-20 9:33am I met Bob Burns on site with the contractor about how to set up the sidewalk. Bob explain what is expected. 4-29-20 3:27pm They have the sidewalk formed up and the aggregate is compacted on the east side on Main st. The curb is set up as well. They are ready to pour.
Sidewalk Inspection Partial 6/26/2020 06/26/2020
Misc

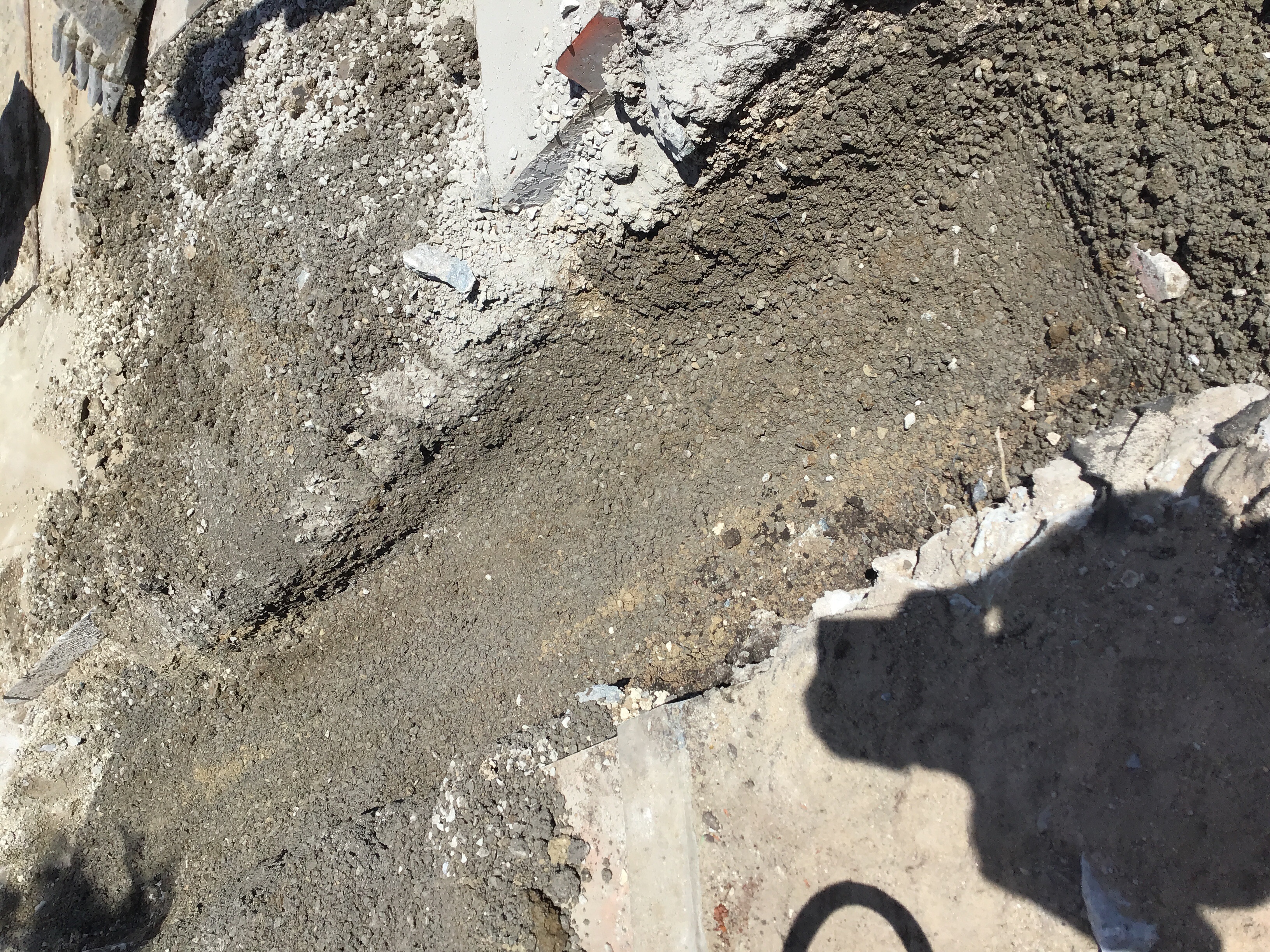

Informational
04/29/2020
3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20. 4-29-20 9:33am I met Bob Burns on site with the contractor about how to set up the sidewalk. Bob explain what is expected. 4-29-20 3:27pm They have the sidewalk formed up and the aggregate is compacted on the east side on Main st. The curb is set up as well. They are ready to pour.
Misc
Informational
06/26/2020
The sidewalk along Market on the back side of the parking lot has been poured, I checked the forms and rock was compacted. The rock was also installed and compacted between the sidewalk and the curb where the decorative pavestone will be installed. The sidewalk between the bank and the museum was formed and had rock installed that has been compacted.
Sidewalk Inspection Partial 6/29/2020 06/29/2020
Misc
Informational
06/26/2020
3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20. 4-29-20 9:33am I met Bob Burns on site with the contractor about how to set up the sidewalk. Bob explain what is expected. 4-29-20 3:27pm They have the sidewalk formed up and the aggregate is compacted on the east side on Main st. The curb is set up as well. They are ready to pour.
Misc
Informational
06/26/2020
The sidewalk along Market on the back side of the parking lot has been poured, I checked the forms and rock was compacted. The rock was also installed and compacted between the sidewalk and the curb where the decorative pavestone will be installed. The sidewalk between the bank and the museum was formed and had rock installed that has been compacted. 6-29-20 10:24am The sidewalk between the bank and the museum has been poured.
Sidewalk Inspection Partial 7/2/2020 07/02/2020
Misc
Informational
06/29/2020
3-31-20 2:24pm They have poured the flume on the south side of the building. They will be setting up the sidewalk on the north side tomorrow 4-1-20. 4-29-20 9:33am I met Bob Burns on site with the contractor about how to set up the sidewalk. Bob explain what is expected. 4-29-20 3:27pm They have the sidewalk formed up and the aggregate is compacted on the east side on Main st. The curb is set up as well. They are ready to pour.
Misc
Informational
06/29/2020
The sidewalk along Market on the back side of the parking lot has been poured, I checked the forms and rock was compacted. The rock was also installed and compacted between the sidewalk and the curb where the decorative pavestone will be installed. The sidewalk between the bank and the museum was formed and had rock installed that has been compacted. 6-29-20 10:24am The sidewalk between the bank and the museum has been poured.
Misc
Informational
07/02/2020

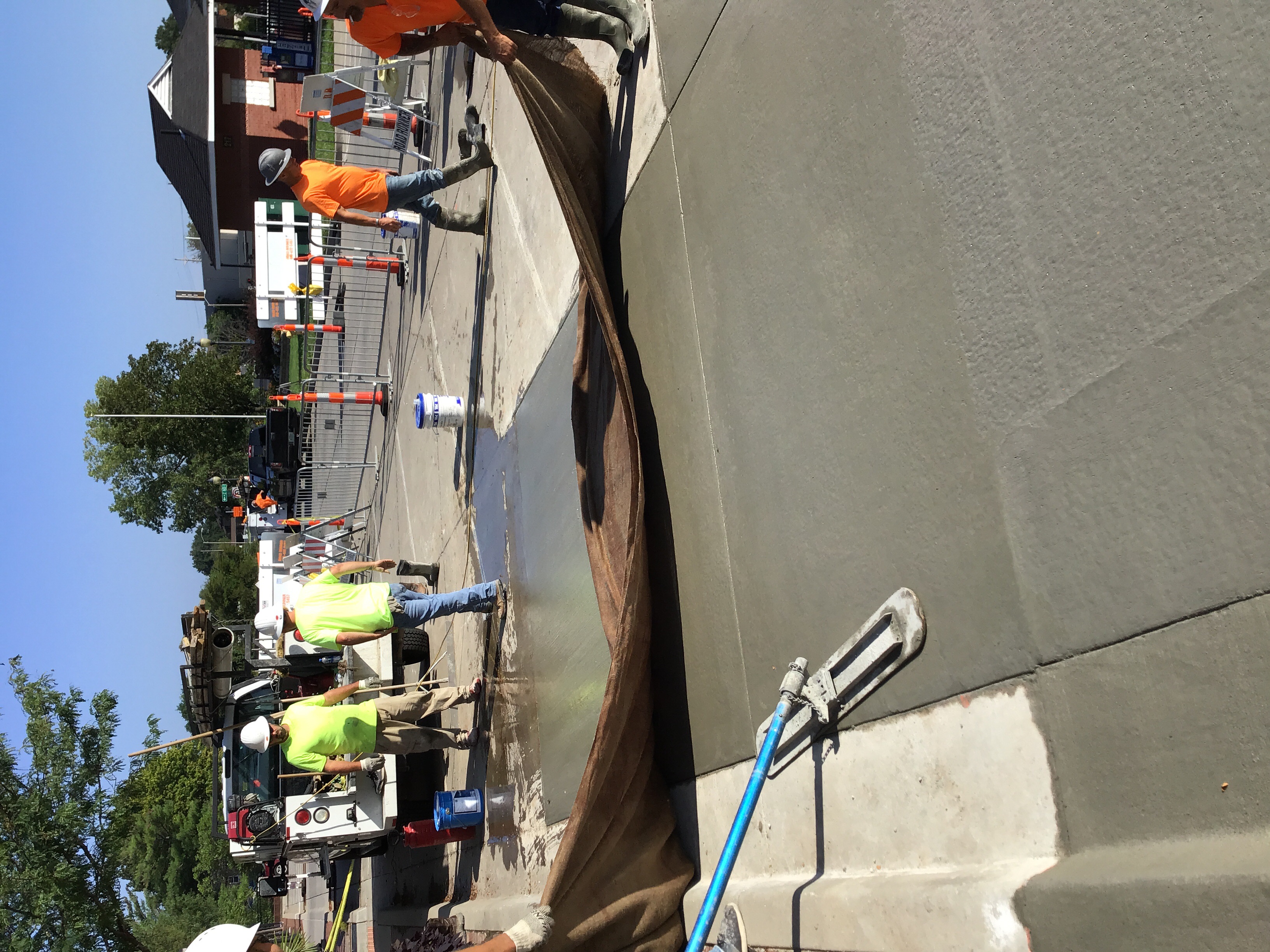

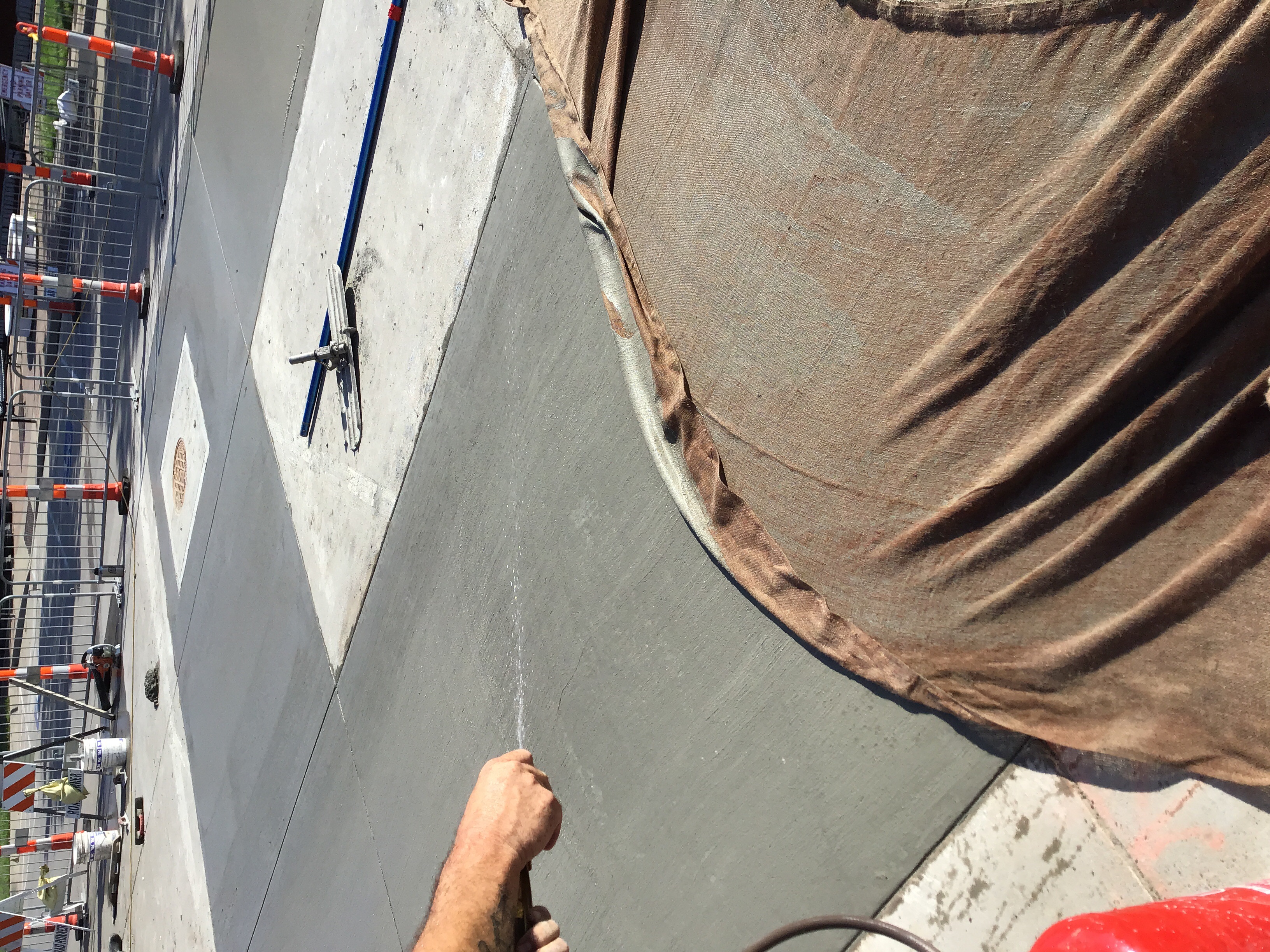

The sidewalks have passed , the contractors are still installing the decortive brick in front of the public sidewalk on market st.
Storm - Pipe Passed 7/2/2020 07/02/2020
Misc
Informational
08/20/2019
8-12-19 The storm pipe has been ran along the west side of the site.
Misc
Informational
08/20/2019
8-13-19 The have installed 30 feet of storm on the east side heading into the street. They are backfilling in lifts and have compacted base.
Misc
Informational
08/20/2019
8-14-19 10am They are coring the manhole for the storm pipe. 3:00pm They have 60 feet installed and are backfilling.
Misc
Informational
08/20/2019
8-15-19 9:00am They have placed 40 foot of storm pipe and are backfilling before they continue. 1:20pm They have 20 more feet of pipe installed and are digging out for the box.
Misc
Informational
08/20/2019
8-19-19 11:15am They are setting up to place the box in Main st. On the north east side of the site. 3:50pm They have the box installed and will be pouring the collars and invert on Tuesday 8-20-19.
Misc
Informational
08/20/2019
8-20-19 They have poured the collars and invert for the box and will be backfilling with flowable fill. 9:05am They have backfilled with flowable fill.
PW-Misc
Informational
07/02/2020
All the storm pipes and roof drains have been completed.
Water Line - Construction Taps Removed Passed 07/02/2020
Grading/Excavation/Fill Inspection Passed 07/02/2020
Curb - Proof Roll Passed 07/02/2020
Pavement-Proof Roll Passed 07/02/2020
Pavement-Surface Passed 07/02/2020
Storm - Material Verification Passed 07/02/2020
Storm - Inlets Clean Passed 07/02/2020
Water - Material Verification Passed 07/02/2020
Water Line - Construction Inspection Passed 07/02/2020
Misc
Informational
08/05/2019
7-5-19 The crew are getting things ready to pour the thrust blocks on the water main.
Misc
Informational
08/06/2019
7-5-19 The crew are getting things ready to pour the thrust blocks on the water main.
Misc
Informational
08/06/2019
7-6-19 9:am They are backfilling in 12” lifts the water main with type 5 rock.
Erosion Control Inspection Passed 07/02/2020
Water Line - Thrust Restraint Passed 07/02/2020
Misc
Informational
08/05/2019
7-5-19 They have poured the thrust restraints for the main.
Documents & Images
Date Uploaded File Type Document Name
07/11/2019 Receipt Receipt for transaction: 2019-004703
07/16/2019 signed permit Reece Nichols
07/30/2019 Water material
07/30/2019 Letter INSPECTION SUMMARY
07/30/2019 Water main
08/01/2019 Letter INSPECTION SUMMARY
08/05/2019 Water main
08/05/2019 Water main0

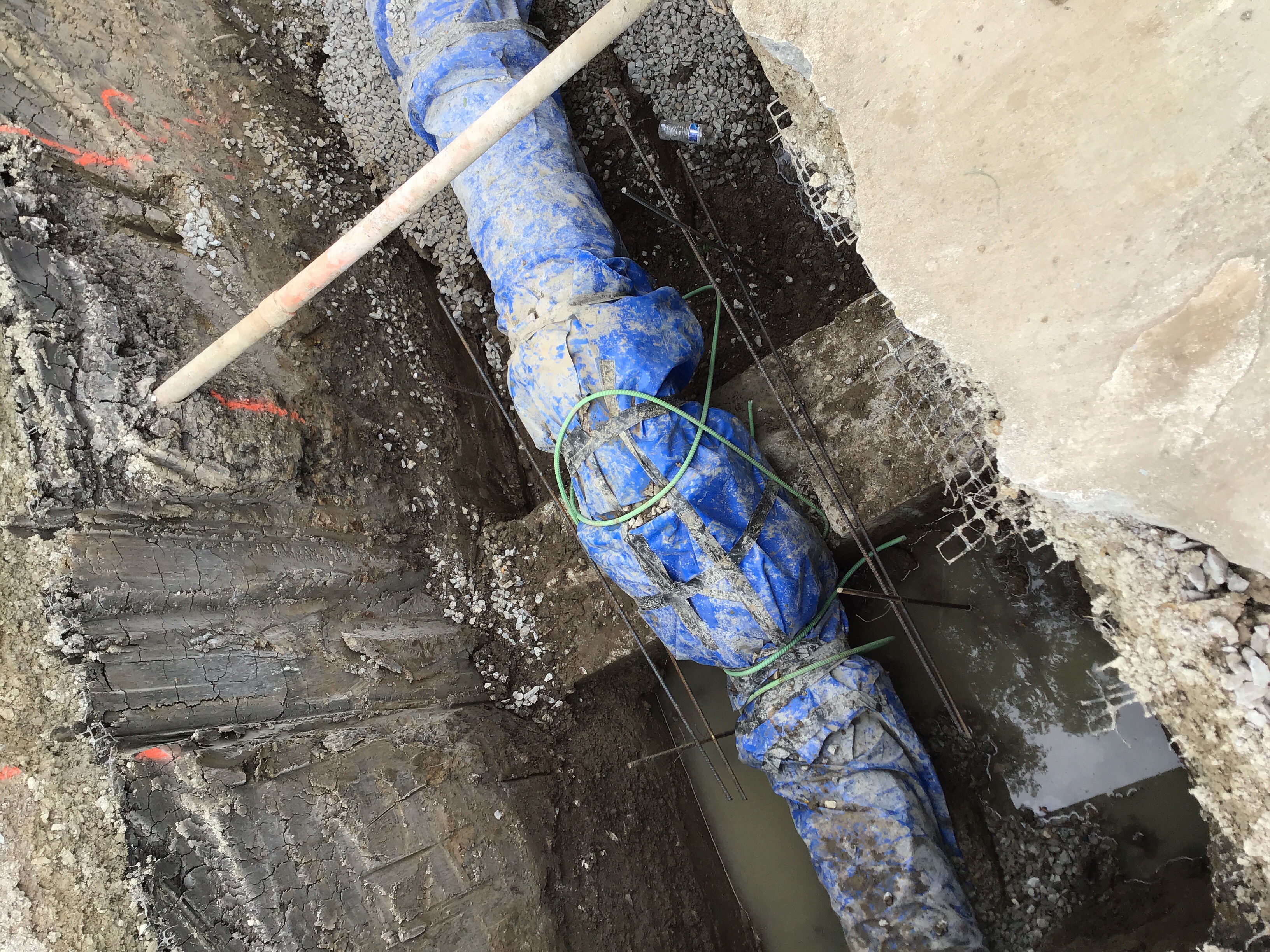

08/05/2019 Water main thrust restraint
08/05/2019 Water main rebar north side
08/05/2019 Letter INSPECTION SUMMARY

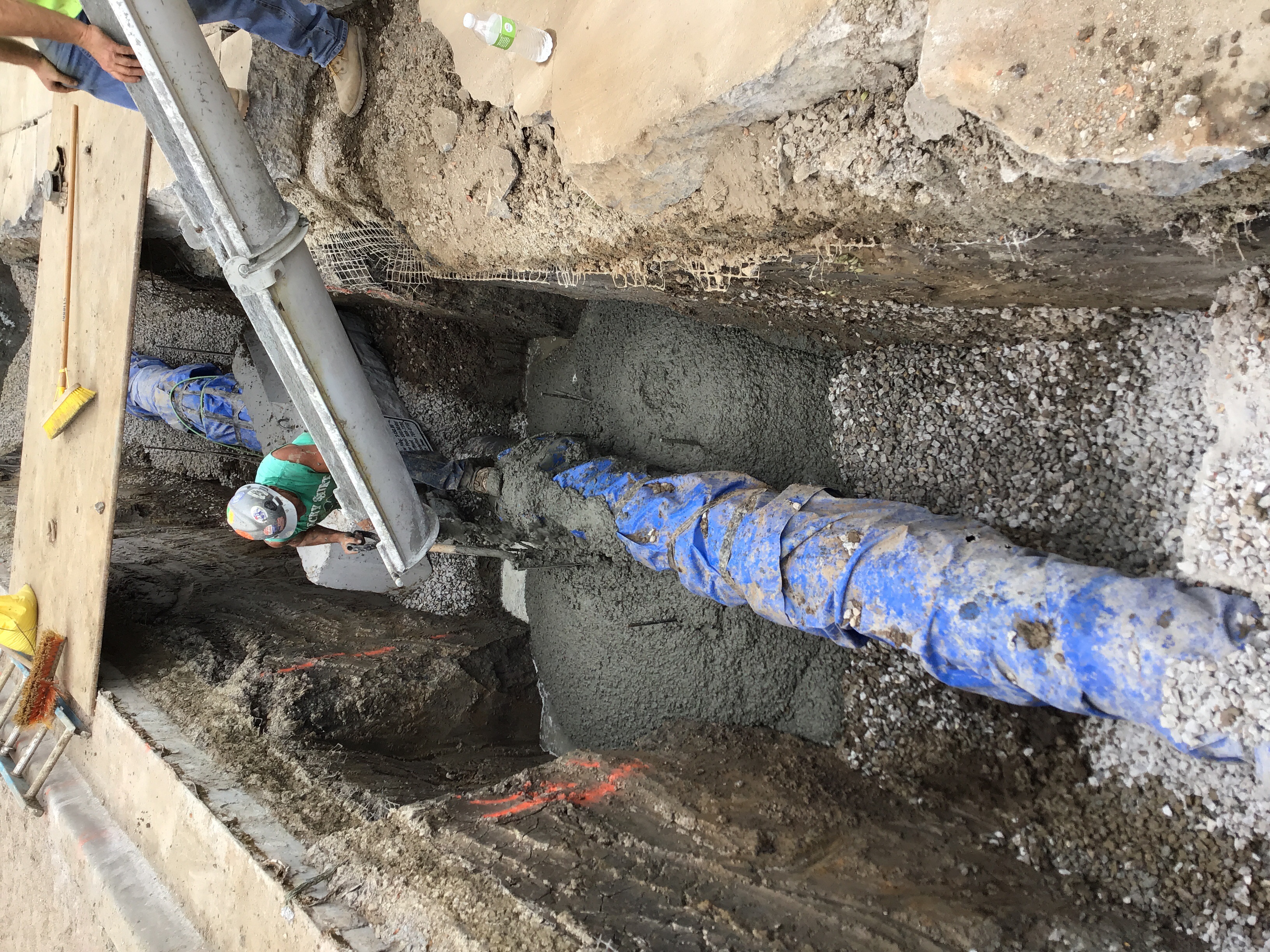

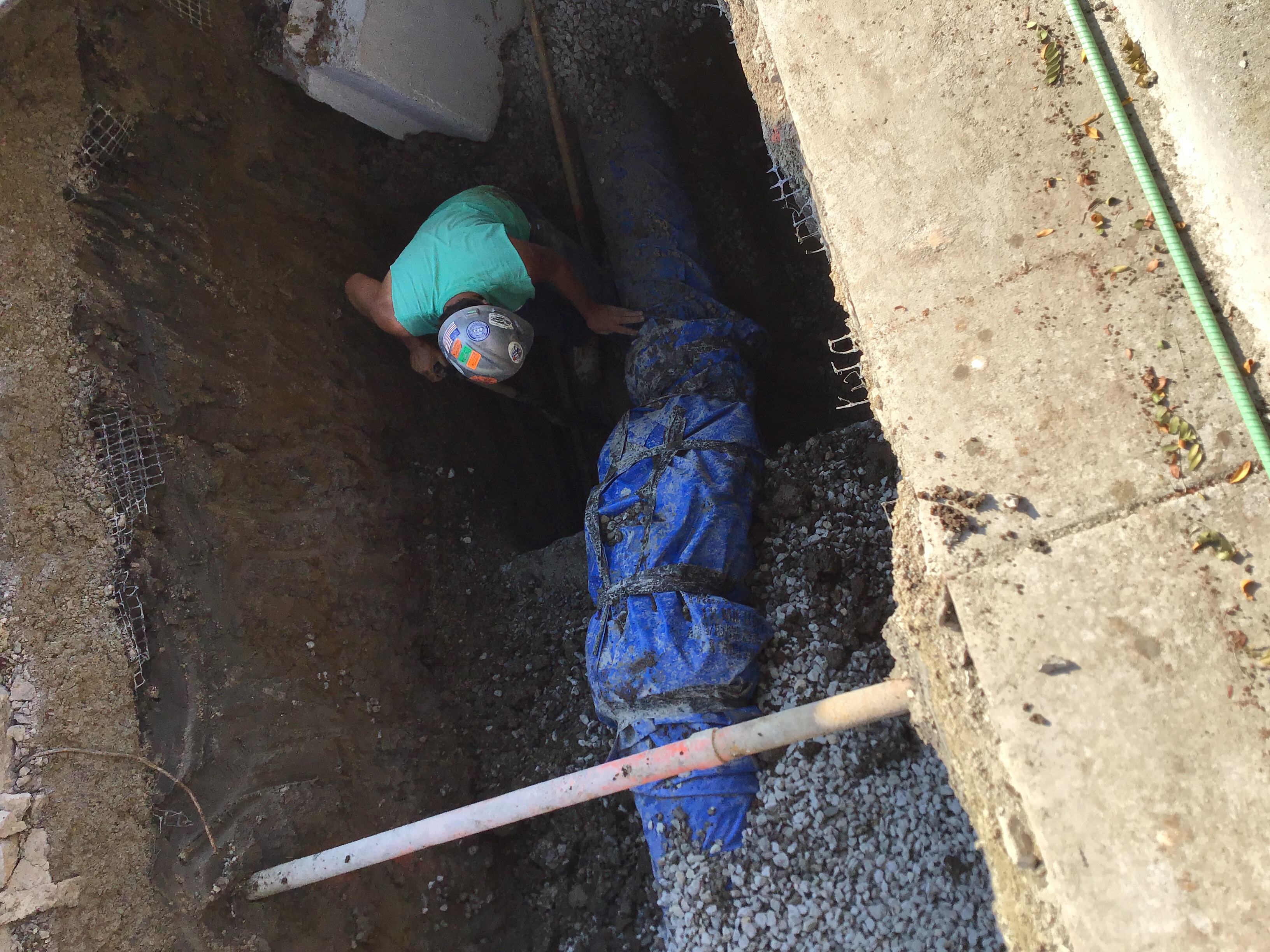

08/06/2019 Water main backfill
08/13/2019 Storm pipe heading into the street

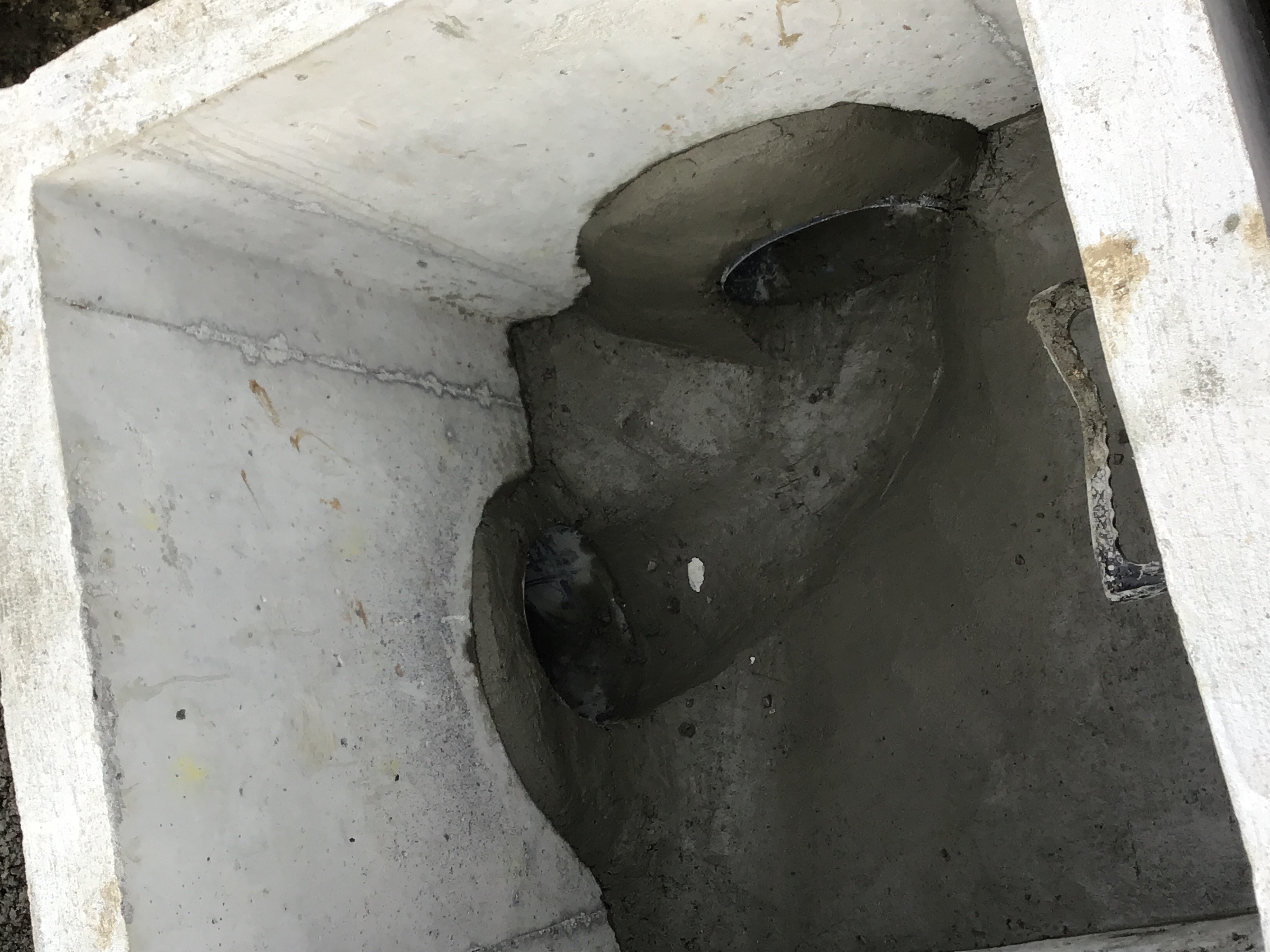

08/14/2019 Coring into the manhole
08/14/2019 Letter INSPECTION SUMMARY
08/20/2019 Collar
08/20/2019 Box invert
08/20/2019 Drain on north side
08/20/2019 Flowable fill around box
08/20/2019 Letter INSPECTION SUMMARY
08/21/2019 Letter INSPECTION SUMMARY

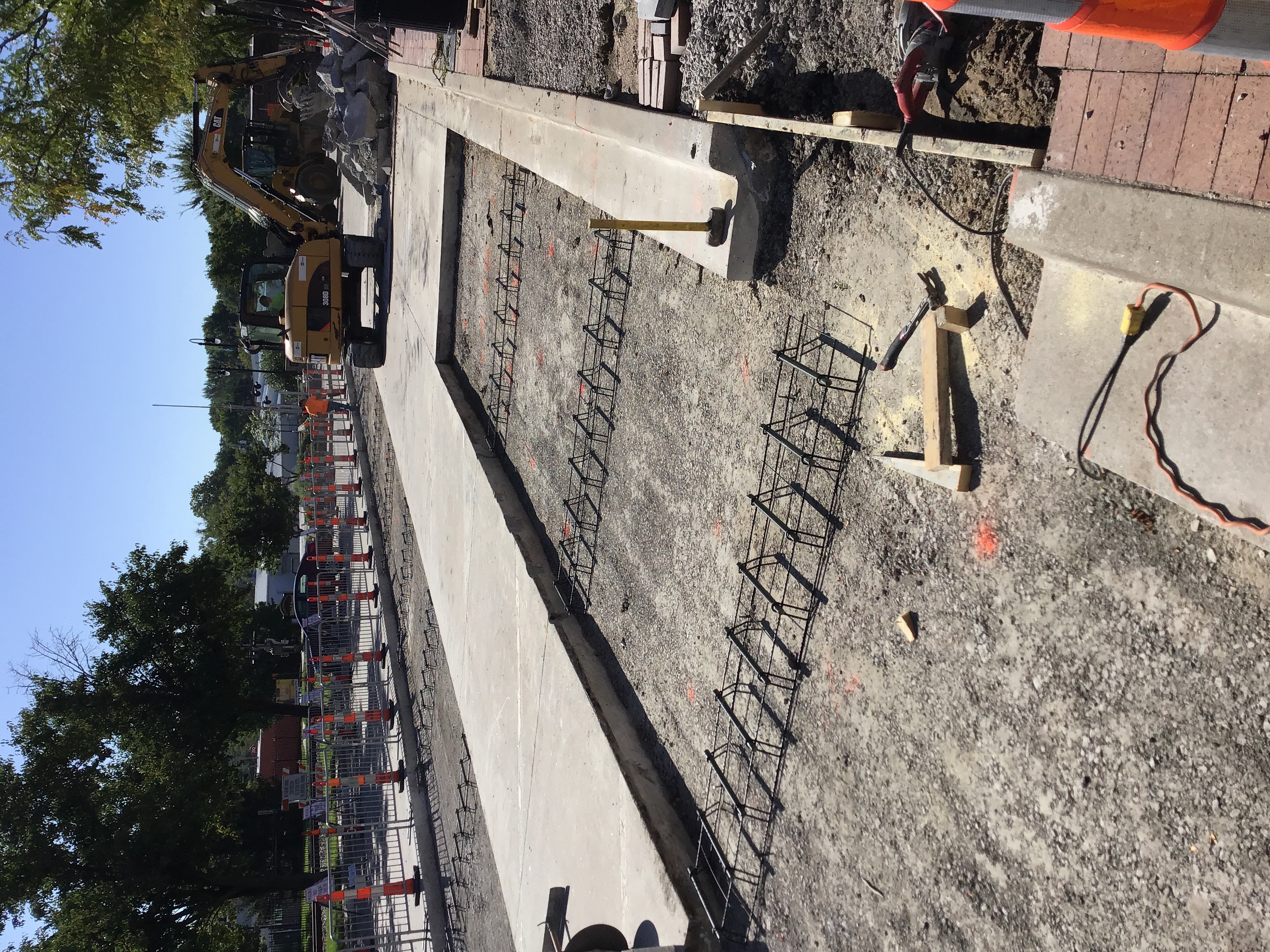

08/28/2019 Main Street prep
08/28/2019 Rebar by storm box
08/28/2019 Main st
08/28/2019 Main st2
08/29/2019 Concrete ticket

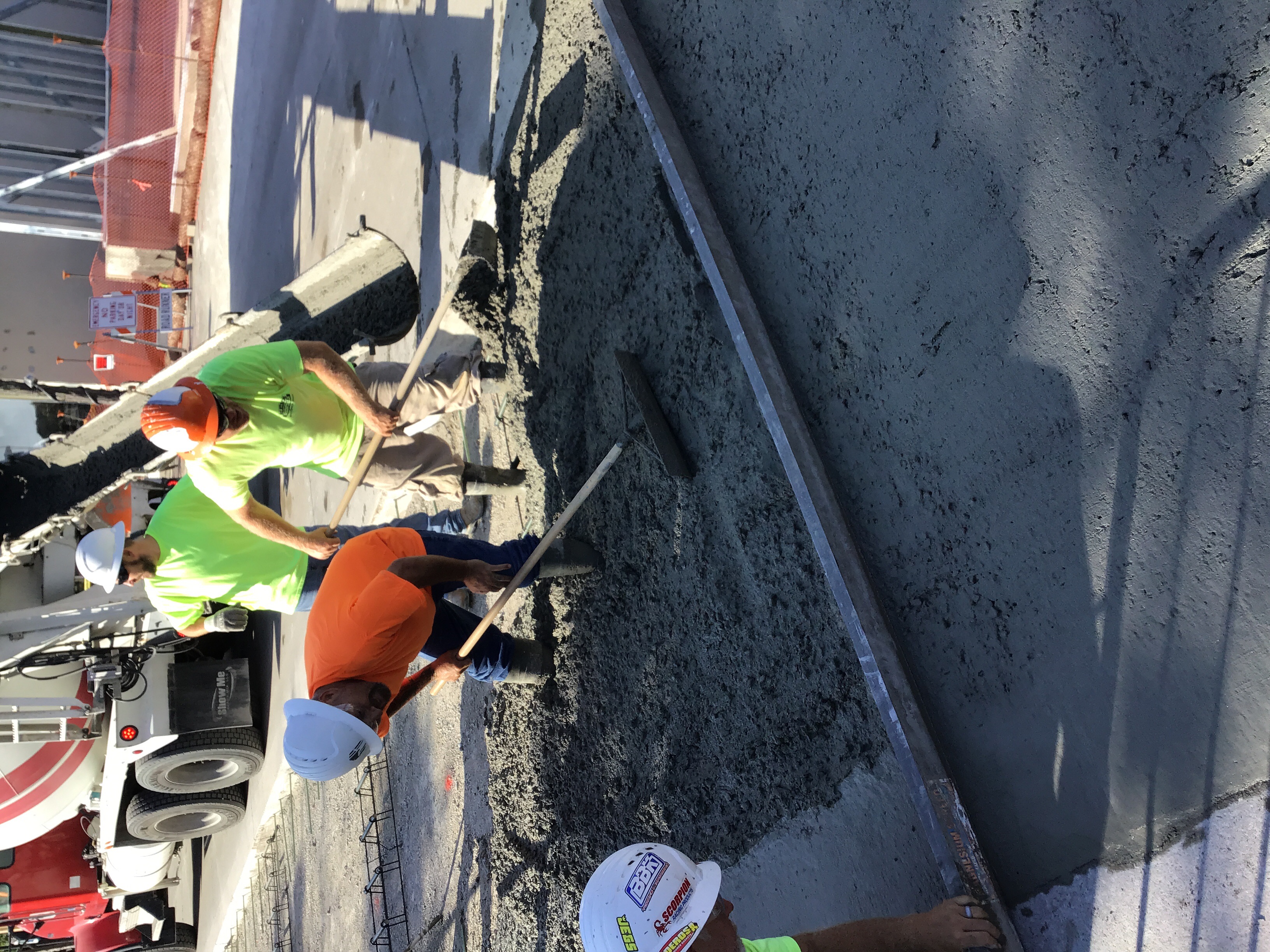

08/29/2019 Concrete pour
08/29/2019 Pour
08/29/2019 Vibrator by the box
08/29/2019 Main st pour
08/29/2019 Main St pour0
08/29/2019 Burlap

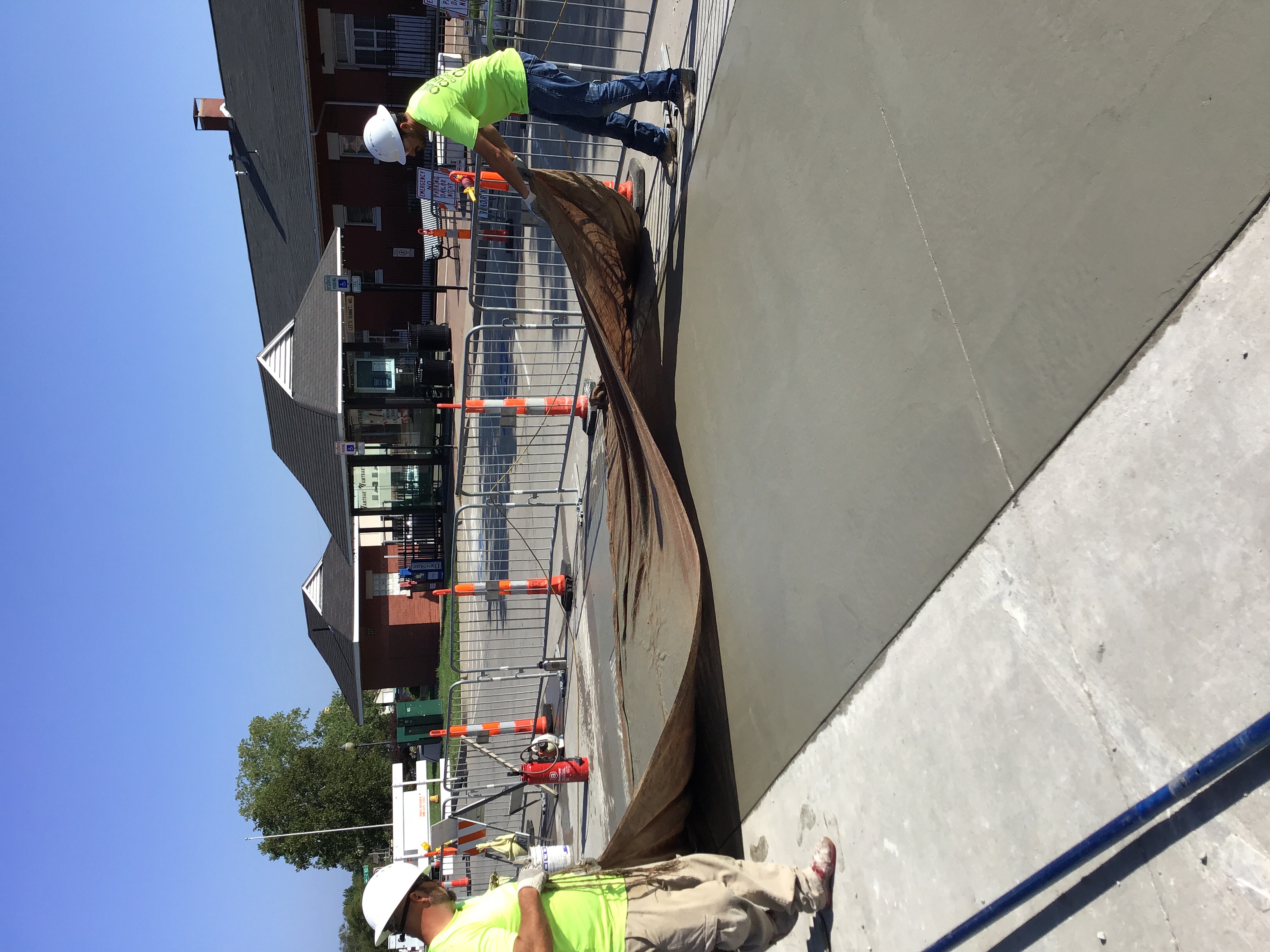

08/29/2019 Pulling burlap
08/29/2019 Burlap 3

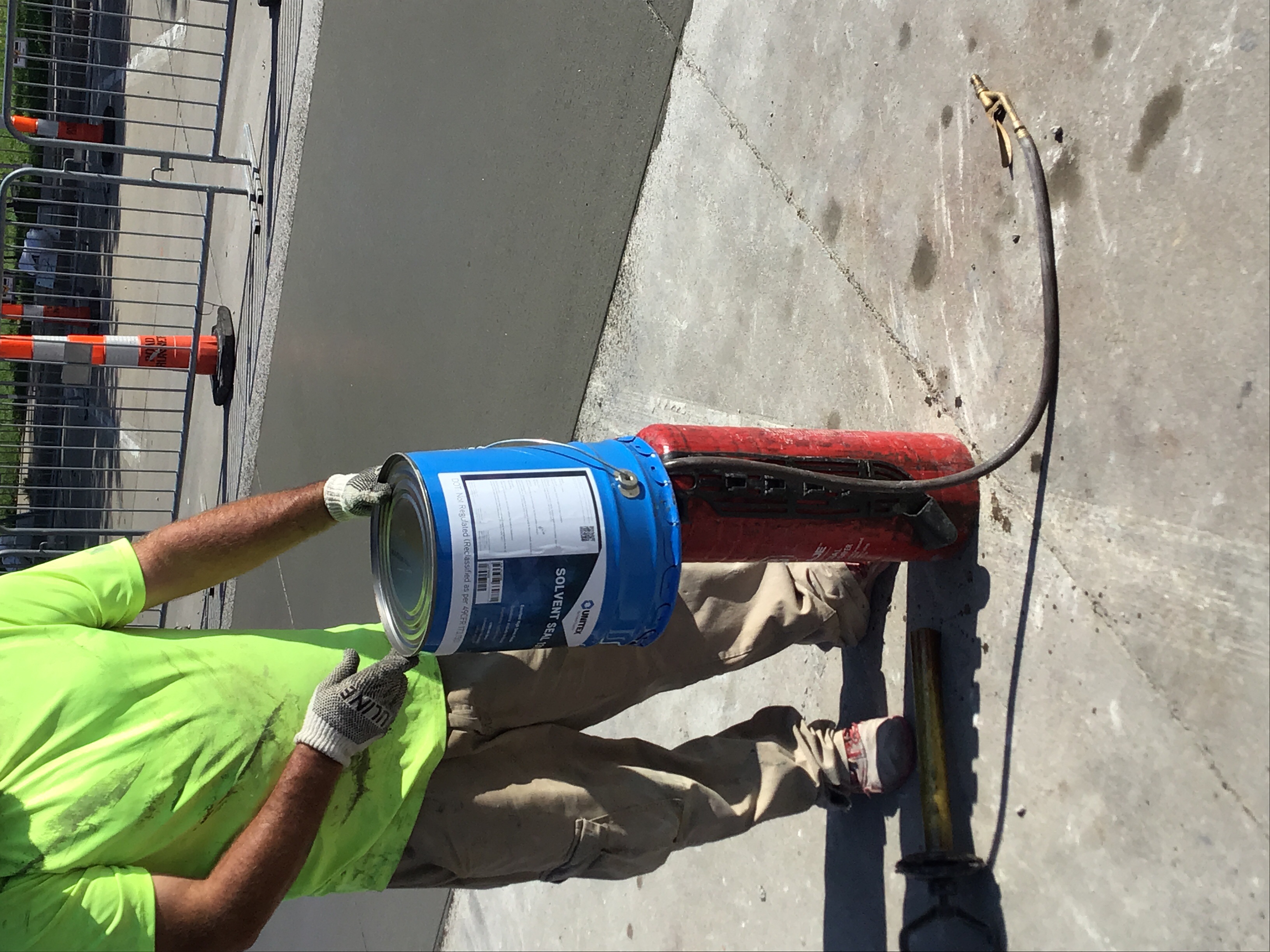

08/29/2019 Clear cure being applied
08/29/2019 Burlap
08/29/2019 Vibrating around the manhole lid
08/29/2019 Cure
08/29/2019 Cure type
08/29/2019 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
03/31/2020 Letter INSPECTION SUMMARY
04/28/2020 Letter DE-Daily Inspection Summary
04/29/2020 Letter INSPECTION SUMMARY
04/29/2020 Letter INSPECTION SUMMARY
06/26/2020 Letter DE-Daily Inspection Summary
06/29/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
06/29/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter DE-Daily Inspection Summary
07/02/2020 Letter DE-Daily Inspection Summary
09/01/2020 Letter DE-Punch List
09/01/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
10/07/2020 Reece Easement - recorded
10/07/2020 Reece Row - recorded
11/17/2020 Reece Nichols Maintenance Bond
11/20/2020 Receipt Receipt for transaction:2020-007672
12/15/2020 Reece Nichols Final Affidavit
03/17/2023 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
