Summary


PRSITE20191463
Development - Site
Final Acceptance
BROWNSTONE PROPERTIES-LEE'S SUMMIT LLC
DEVELOPMENT COMPLETE
Full site development
06/06/2019
06/21/2019
11/17/2020
Locations
Contacts
BROWNSTONE PROPERTIES-LEE'S SUMMIT LLC, Address:3351 NE RALPH POWELL RD
AJ BROWN INC, Address:635 TRADE CENTER BLVD, Phone:(636) 537-3636
Jim Hostler, Address:AJ Brown Inc
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 06/06/2019 11/17/2020
Steve Robbins
Fees
Paid Fees Amount Paid Owing Date Paid
Sanitary Sewer Insp Fees $181.51 $181.51 Paid 06/13/2019
Water Insp Fee $391.45 $391.45 Paid 06/13/2019
Water Test Fee $200.00 $200.00 Paid 06/13/2019
Storm Sewer Inspection Fee $1,041.09 $1,041.09 Paid 06/13/2019
Paved Surface Inspection Fee $3,547.99 $3,547.99 Paid 06/13/2019
$3,547.98
Site Grading Fee $4,433.88 $4,433.88 Paid 06/13/2019
Water Tap Fee $22,738.00 $22,738.00 Paid 06/13/2019
Water Meter Fee $2,307.98 $2,307.98 Paid 06/13/2019
Right of Way Permit Fee $80.00 $80.00 Paid 06/13/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Grading/Excavation/Fill Inspection Partial 7/1/2019 07/02/2019
Informational
07/02/2019

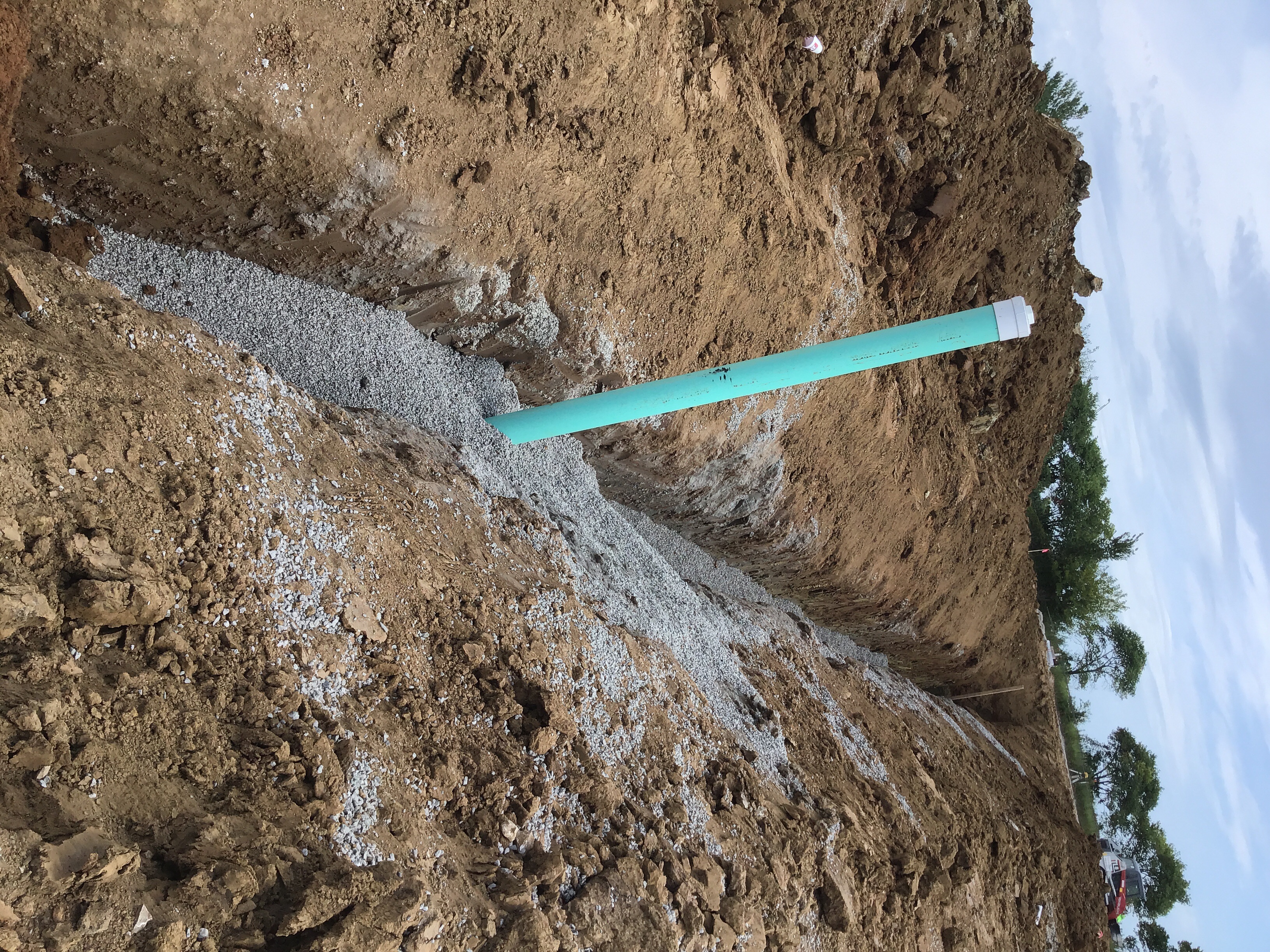

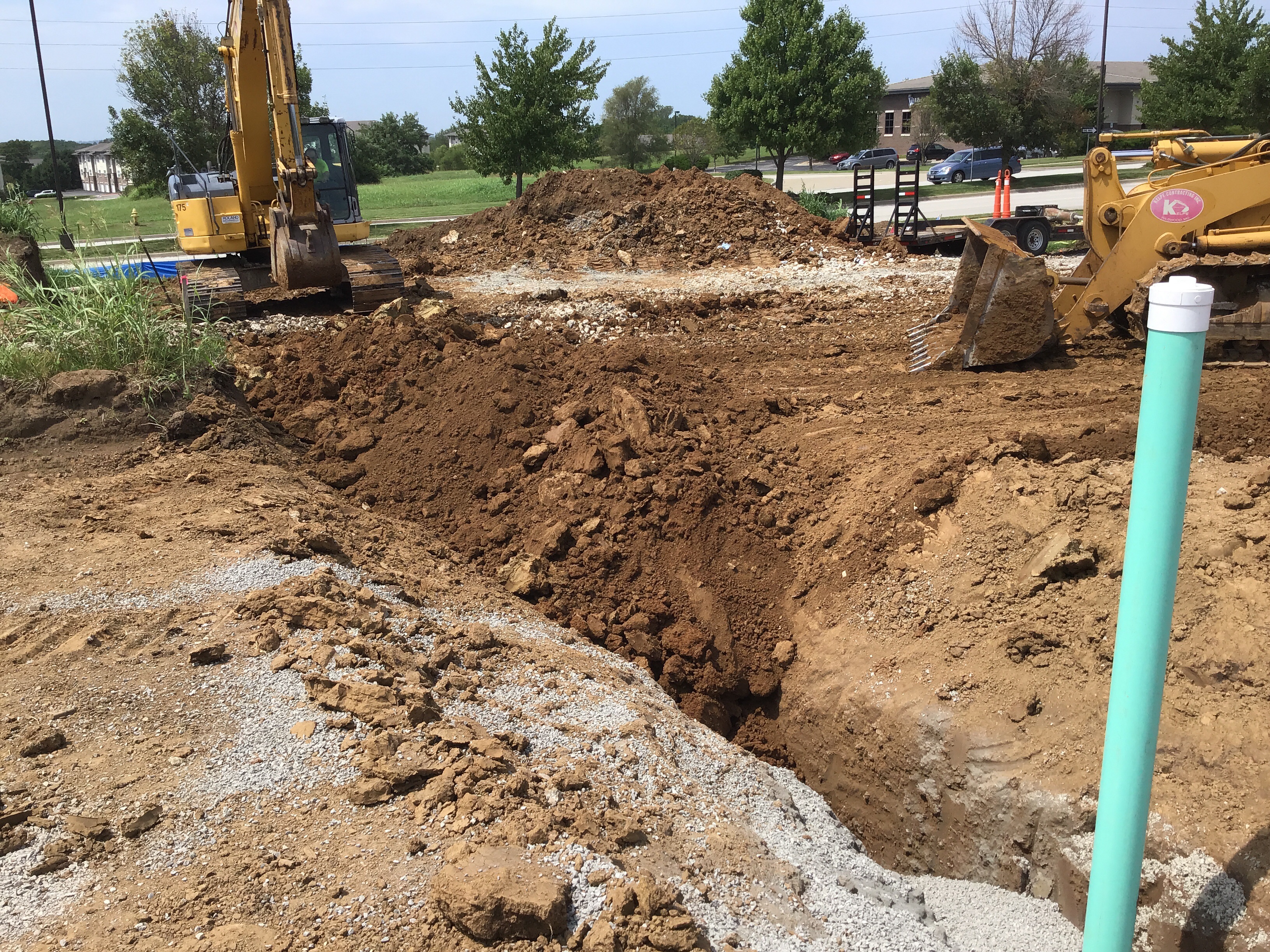

Contractor began grading site for utilities installation . John Jackson 07/02/2019 7:29 AM
Grading/Excavation/Fill Inspection Partial 7/8/2019 07/08/2019
Informational
07/08/2019
Goddard School contractor continued to grade site and install construction entrance .
Grading/Excavation/Fill Inspection Partial 07/10/2019
Misc
Informational
07/10/2019
Contractor continued to construct entrance to site and grading .
Misc
Informational
07/11/2019
Continued to excavate and grade site for future installation of utilities . Contractor also placed contractor construction trailer .
Grading/Excavation/Fill Inspection Partial 07/15/2019
Misc
Informational
07/15/2019
Contractor continued grading and excavating site .
Misc
Informational
07/16/2019
Contractor continued grading and excavating site for base structure of the new building .
Sanitary Sewer Construction Inspection Partial 08/20/2019
Informational
08/20/2019
Contractor tie-in 8x6 wye sanitary line with two 8" hard back Fernco coupling. Approximately 42' of 6"sanitary line.
Misc
Informational
08/20/2019
Contractor installed approximately 140’ of 6” Sanitary Sewer Line.
Storm Sewer Construction Inspection Partial 8/29/2019 at 12:00 PM 08/29/2019
Misc
Informational
08/29/2019
The contractors core drilled into the existing storm box and made the connection of the 3 lines going into the box. They are planning on grouting the pipes in the morning. I let them know they needed to smooth out the inverts as the flow has changed due to the new pipes flowing into the box.Steve Robbins 08/29/2019 4:50 PM
Storm Sewer Construction Inspection Partial 9/5/2019 09/09/2019
Misc
Informational
08/29/2019
The contractors core drilled into the existing storm box and made the connection of the 3 lines going into the box. They are planning on grouting the pipes in the morning. I let them know they needed to smooth out the inverts as the flow has changed due to the new pipes flowing into the box.Steve Robbins 08/29/2019 4:50 PM
Informational
09/09/2019
Contractor installed storm boxes and poured inverts. Storm lines were installed to newly installed storm boxes.
Sanitary Sewer Construction Inspection Passed 09/17/2019
Misc
Informational
09/17/2019
Misc
Informational
09/17/2019
Contractor installed approximately 60’ of 6” SDR-26 Sewer main. Contractor end installation at proposed build structure with a Fernco Hard back coupling. 2/45 degree 6” bends where install on line 55” piece of. 6” is between the 2/45 degree bends.
Fire Line Construction Inspection Partial 09/17/2019
Misc
Informational
09/17/2019
Contractor began construction on Fire Line. 9/17/19
Misc
Informational
11/20/2019
Contractor installed approximately 166’ of Fire Line 6” SDR-26 PVC . 2/45 bends were included with the Fire Line. Contractor began to backfilled excavation .
Storm - Outlet Structure Partial 10/07/2019
Misc
Informational
10/07/2019
Storm outlet box Cl 1-2 was installed. Storm box was installed as per revision.
Storm - Pipe Partial 10/08/2019
Misc
Informational
10/08/2019
Contractor worked on Storm Line #1 installing 111’ of 15” HDPE pipe. Contractor backfilled excavation.
Storm - Pipe Partial 10/17/2019 10/17/2019
Misc
Informational
10/08/2019
Contractor worked on Storm Line #1 installing 111’ of 15” HDPE pipe. Contractor backfilled excavation.
Informational
10/17/2019
Contractor installed approximately 80' of of 15" of HPDE storm piping on 10/16/19 and 50' of 15" HPDE storm piping on 10/17/19. Contractor backfill excavated site. Installation of storm pipe will continue tomorrow 10/18/19.
Water Line - Construction Inspection Partial 11/14/2019 10/19/2019
Misc
Informational
09/17/2019

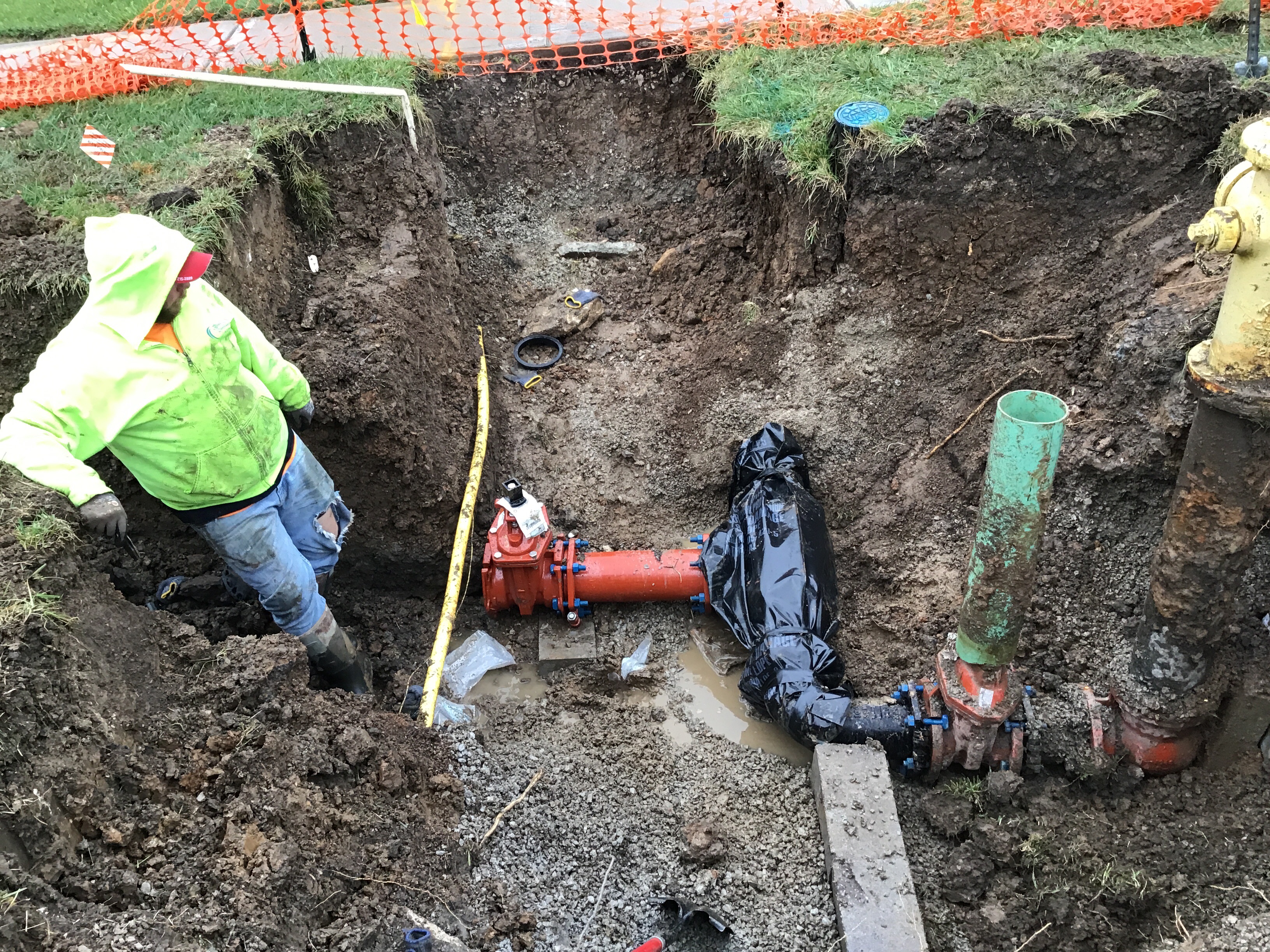

Tie-in of 6x8 Tee, 6” valve & and relocation of existing Fire Hydarnt . The 90 degree “J” bend was replaced on the existing Fire Hydrant. All fitting have been mega lugged and contractor wrapped all installed DIP pipping with poly wrap. Contractor will fence off excavated area to pour thrust block behind 6”X8” Tee for Goddard School.
Informational
11/14/2019
Contractor installed approximately 50' of 6" PVC water pipe newly installed fire line. Newly installed 6"gate valves was moved a few feet from where project plans indicates (this will be reflected in the as-built). A 45 degree bend was also include in the installation as per plans 11/13/19. On 11/12/19 contractor began BackFlow Vault on Fire Line as per.
Storm - Pipe Partial 10/21/2019
Misc
Informational
10/21/2019
Contractor installed 56’ of 15” HDPE storm pipe on line #1. Contractor plans to pour collars and inverts inlet F1 1-1 , C1 1-2 & existing field inlet.
Storm Sewer Construction Inspection Passed 9/10/2019 (P.M.) 9/10/2019 10/22/2019
Misc
Informational
10/22/2019
Contractor pour collars and inverts on storm line #1.
Water Line - Construction Inspection Partial 10/22/2019
Misc
Informational
10/19/2019
Tie-in of 6x8 Tee, 6” valve & and relocation of existing Fire Hydarnt . The 90 degree “J” bend was replaced on the existing Fire Hydrant. All fitting have been mega lugged and contractor wrapped all installed DIP pipping with poly wrap. Contractor will fence off excavated area to pour thrust block behind 6”X8” Tee for Goddard School.
Misc
Informational
10/22/2019

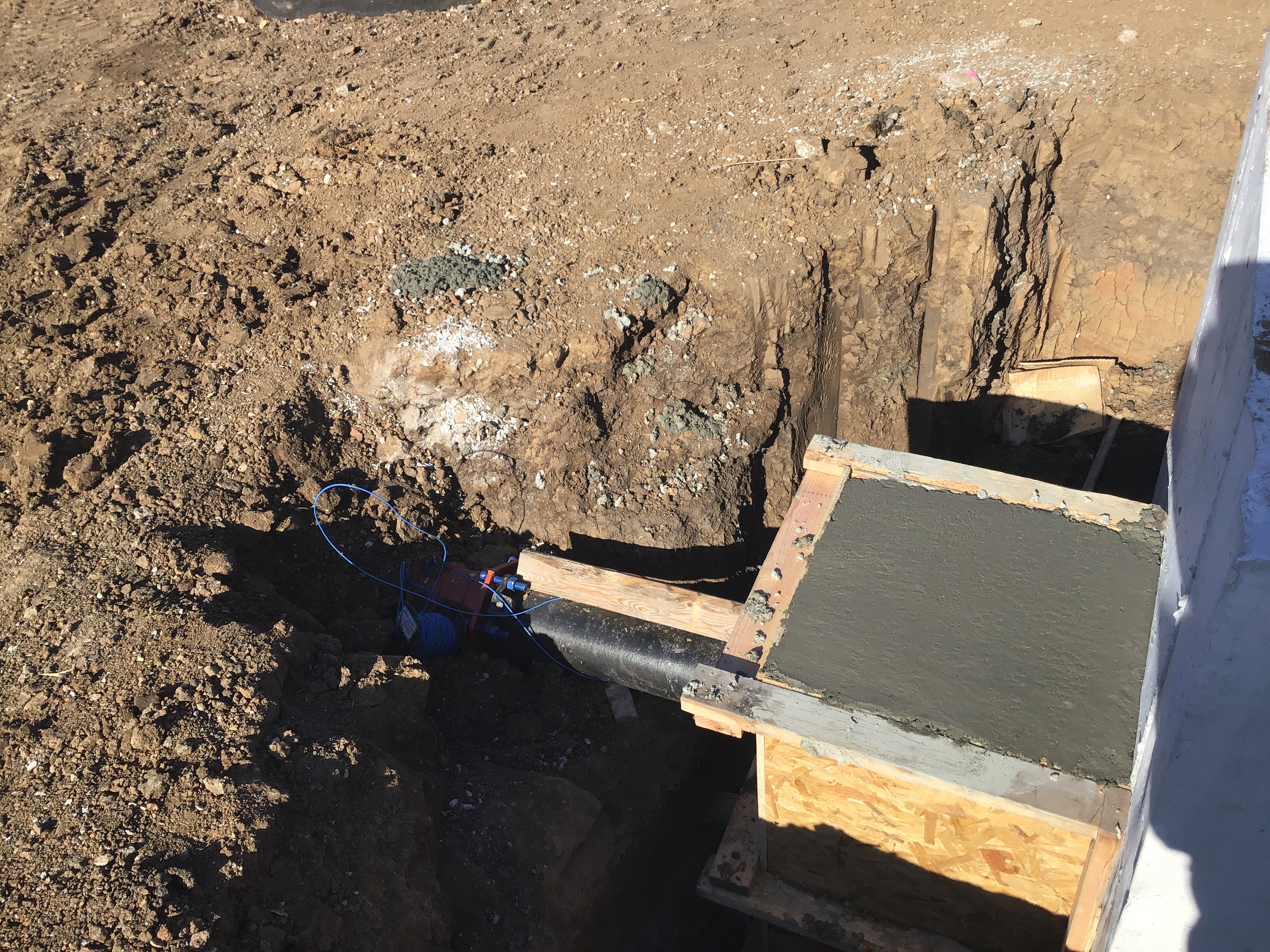

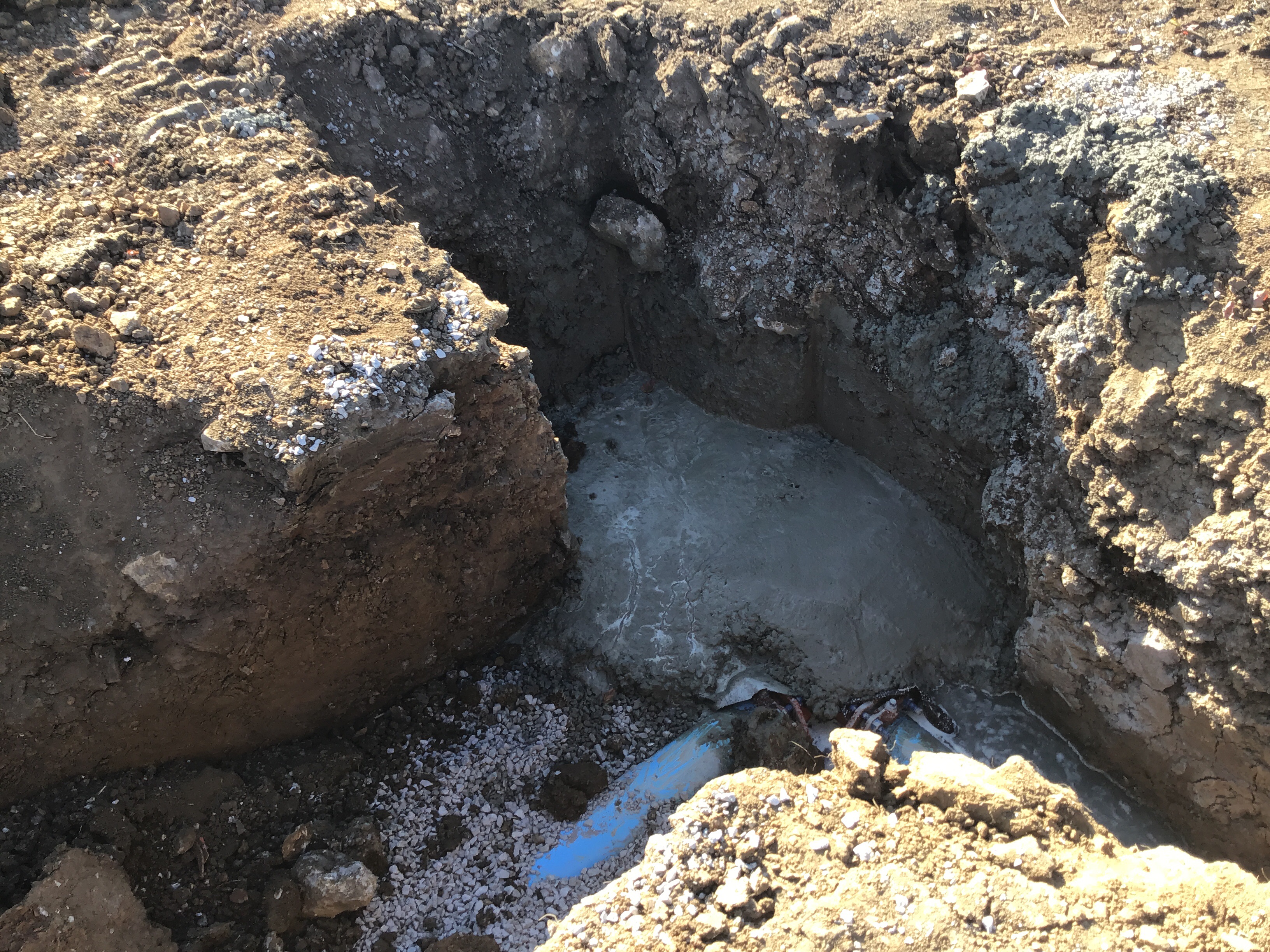

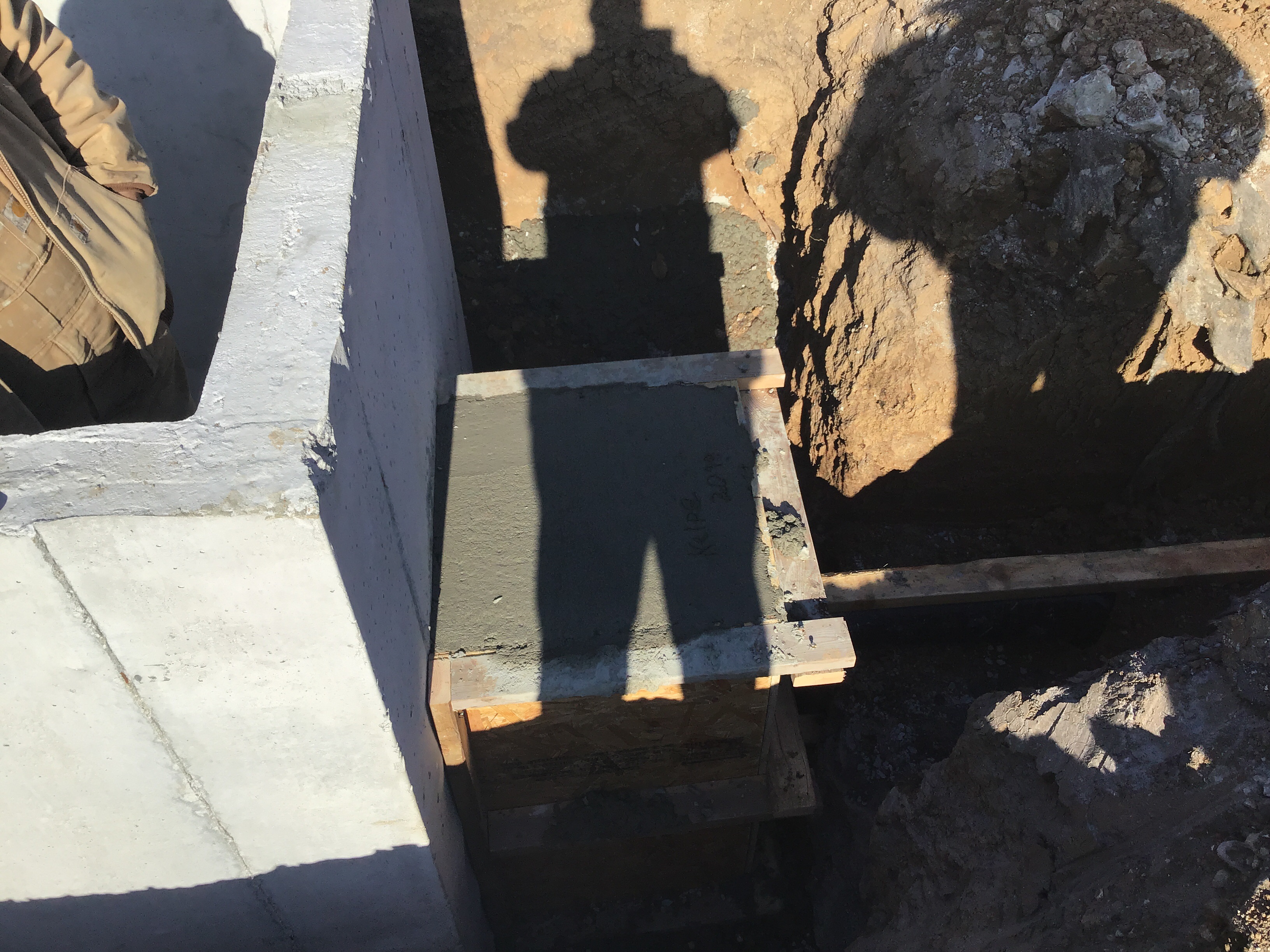

Contractor poured thrust block behind 8”X6” Tee that was installed on Saturday 10/19/19.
Misc
Informational
11/08/2019
Contractor installed 50’ of 6” PVC line and 6” gate valve on Fire Line. 11/8/19
Misc
Informational
11/14/2019
Contractor continued to construction back flow vault that began 11/12/19 poured two straddle.
Storm - Pipe Partial 10/23/2019
Misc
Informational
10/21/2019
Contractor installed 56’ of 15” HDPE storm pipe on line #1. Contractor plans to pour collars and inverts inlet F1 1-1 , C1 1-2 & existing field inlet.
Misc
Informational
10/23/2019
Contractor installed approximately 50’ of 15” HDPE storm pipe Line #1. Contractor stopped installation right before Sta: 3+50 15 Nyoplast inlet. Area has a significant amount of rock.
Storm - Pipe Passed 10/25/2019
Misc
Informational
10/23/2019
Contractor installed 56’ of 15” HDPE storm pipe on line #1. Contractor plans to pour collars and inverts inlet F1 1-1 , C1 1-2 & existing field inlet.
Misc
Informational
10/23/2019
Contractor installed approximately 50’ of 15” HDPE storm pipe Line #1. Contractor stopped installation right before Sta: 3+50 15 Nyoplast inlet. Area has a significant amount of rock.
Misc
Informational
10/25/2019
Contractor was able to install approximately 135’ of 15” HDPE storm pipe Line #1 from Sta 3+50 to 4+85 from 10/24/19 to 10/25/19
Roof Drain Partial 10/30/2019
Misc
Informational
10/30/2019
Contractor installed drain pipes in the ground that run to the 90 deg bend to the roof drains 10/28/19.
Water Line - Construction Inspection Partial 11/21/2019
Misc
Informational
10/22/2019
Tie-in of 6x8 Tee, 6” valve & and relocation of existing Fire Hydarnt . The 90 degree “J” bend was replaced on the existing Fire Hydrant. All fitting have been mega lugged and contractor wrapped all installed DIP pipping with poly wrap. Contractor will fence off excavated area to pour thrust block behind 6”X8” Tee for Goddard School.
Misc
Informational
10/22/2019
Contractor poured thrust block behind 8”X6” Tee that was installed on Saturday 10/19/19.
Misc
Informational
11/21/2019
Contractor began to installed 2” Blue Poly Domestic water main. 11/21/19
Fire Line - Hydrostatic Test Passed 12/12/2019
Misc
Informational
12/12/2019

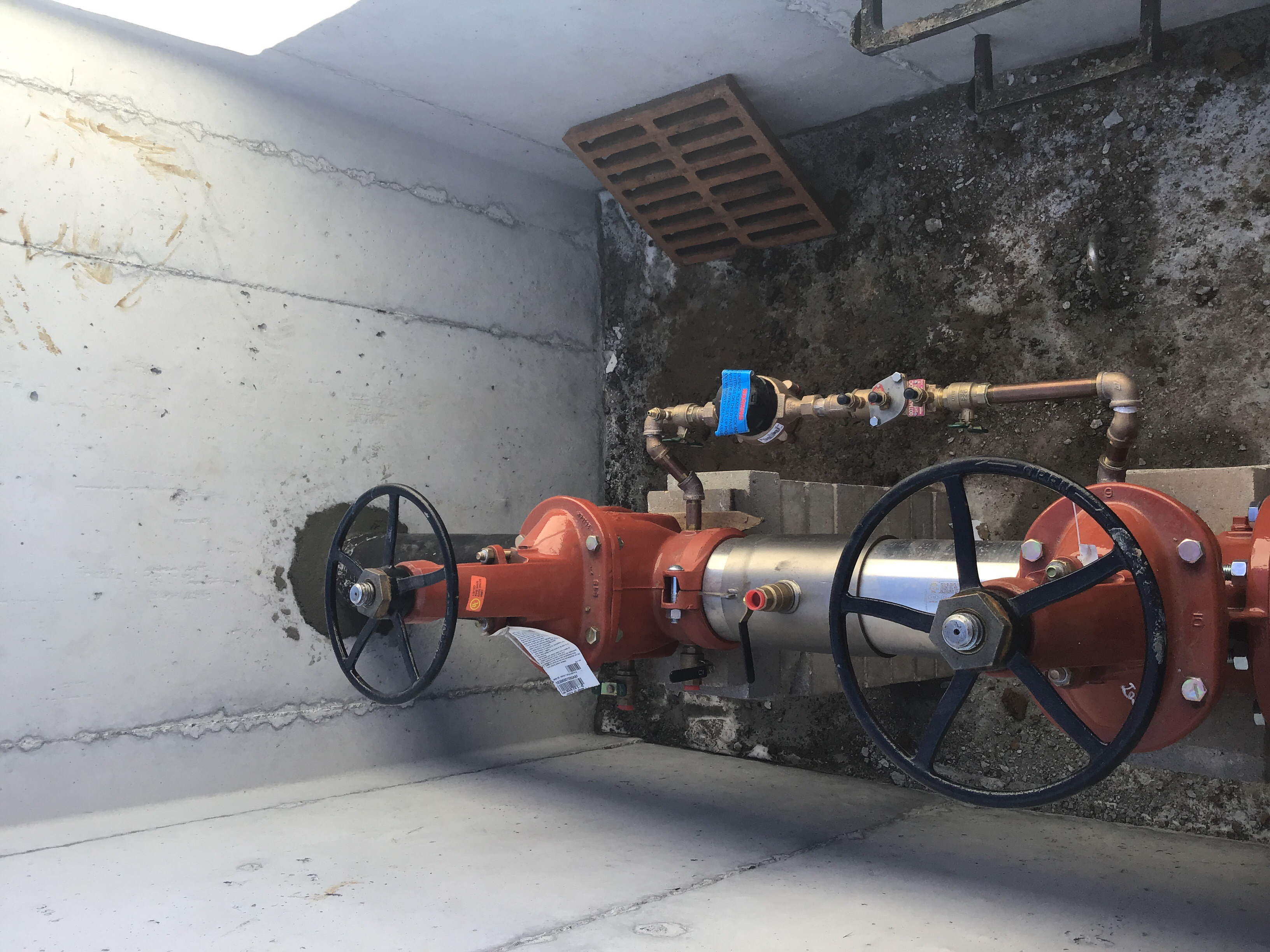

Domestic Water main & Fire Line were tested at 200 psi for 2 hours.
Water Line - Coliform Test 1 Partial 12/20/2019
Informational
12/20/2019
Contractor pulled the first sample on 12/18/19 Wednesday & the second sample on 12/19/19 on Thursday. The first sample passed Ecoli and Coliform test.
Water Line - Construction Inspection Partial 12/23/2019 12/24/2019
Informational
12/24/2019
Water meter was installed for site by contractor as per plans.
Curb - Proof Roll Passed 4/3/2020 04/07/2020
Misc
Informational
04/07/2020
We did a proofroll for the curbs with a 3rd party inspector, they did not put geo-grid or chemical stabiliztion down. Contractor has installed a lot of rock throughout the project and has a very solid base. If a geo-tech engineer will confirm that the subgrade is stabilzed as good or better that geo-grid then we will let them asphalt it. For now i let them start installed curbs for the private parking lot because the 3rd party agreed it was stable and so did i. If they do not get appproval they will have to regrade the parking lot and install geo-grid and type 3 rock as per the plans.
Pavement-Curb Construction Partial 04/15/2020
Misc
Corrective Action Required
04/15/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Pavement-Curb Construction Partial 04/23/2020
Misc
Corrective Action Required
04/15/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Misc
Informational
04/23/2020
Contractor patch and smooth over the honeycombs on the backside of curb 4/21/20.
Site Visit Partial 04/24/2020
Misc
Informational
04/24/2020
Contractor not working due to the rainy conditions. 4//24/20
Curb - Proof Roll Partial 05/01/2020
Misc
Informational
05/01/2020
Proof roll passed further testing.
Sidewalk Inspection Partial 05/06/2020
Misc
Informational
05/06/2020
Contractor began to establish subgrade for sidewalk.
Sidewalk Inspection Partial 05/06/2020
Misc
Informational
05/06/2020
Contractor began to establish subgrade for sidewalk.
Misc
Informational
05/06/2020
Pavement-Curb Construction Partial 05/07/2020
Misc
Corrective Action Required
04/23/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Misc
Informational
04/23/2020
Contractor patch and smooth over the honeycombs on the backside of curb 4/21/20.
Misc
Informational
05/07/2020
Contractor poured curb & sidewalk on project. 5/7/20 43 degree Sunny.
Sidewalk Inspection Partial 05/07/2020
Misc
Informational
05/06/2020
Contractor began to establish subgrade for sidewalk.
Misc
Informational
05/06/2020
Contractor will be pouring public sidewalk today 5/7/20 43 degrees Sunny & rising.
Pavement-Curb Construction Partial 05/08/2020
Misc
Corrective Action Required
05/07/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Misc
Informational
05/07/2020
Contractor patch and smooth over the honeycombs on the backside of curb 4/21/20.
Misc
Informational
05/07/2020
Contractor poured curb & sidewalk on project. 5/7/20 43 degree Sunny.
Misc
Informational
05/08/2020
Contractor continued to pour curbs on the Westside of parking lot. Temperature at @ 9:50 was 51 degrees rising & sunny.
Pavement-Curb Construction Partial 05/12/2020
Misc
Corrective Action Required
05/08/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Misc
Informational
05/08/2020
Contractor patch and smooth over the honeycombs on the backside of curb 4/21/20.
Misc
Informational
05/08/2020
Contractor poured curb & sidewalk on project. 5/7/20 43 degree Sunny.
Misc
Informational
05/08/2020
Contractor continued to pour curbs on the Westside of parking lot. Temperature at @ 9:50 was 51 degrees rising & sunny.
Misc
Informational
05/12/2020
Contractor poured curbs on the Northside of parking lot.
Erosion Control Inspection Partial 05/28/2020
Misc
Informational
05/28/2020
Erosion control is still in place.
Pavement-Surface Passed 06/09/2020
Misc
Informational
06/09/2020

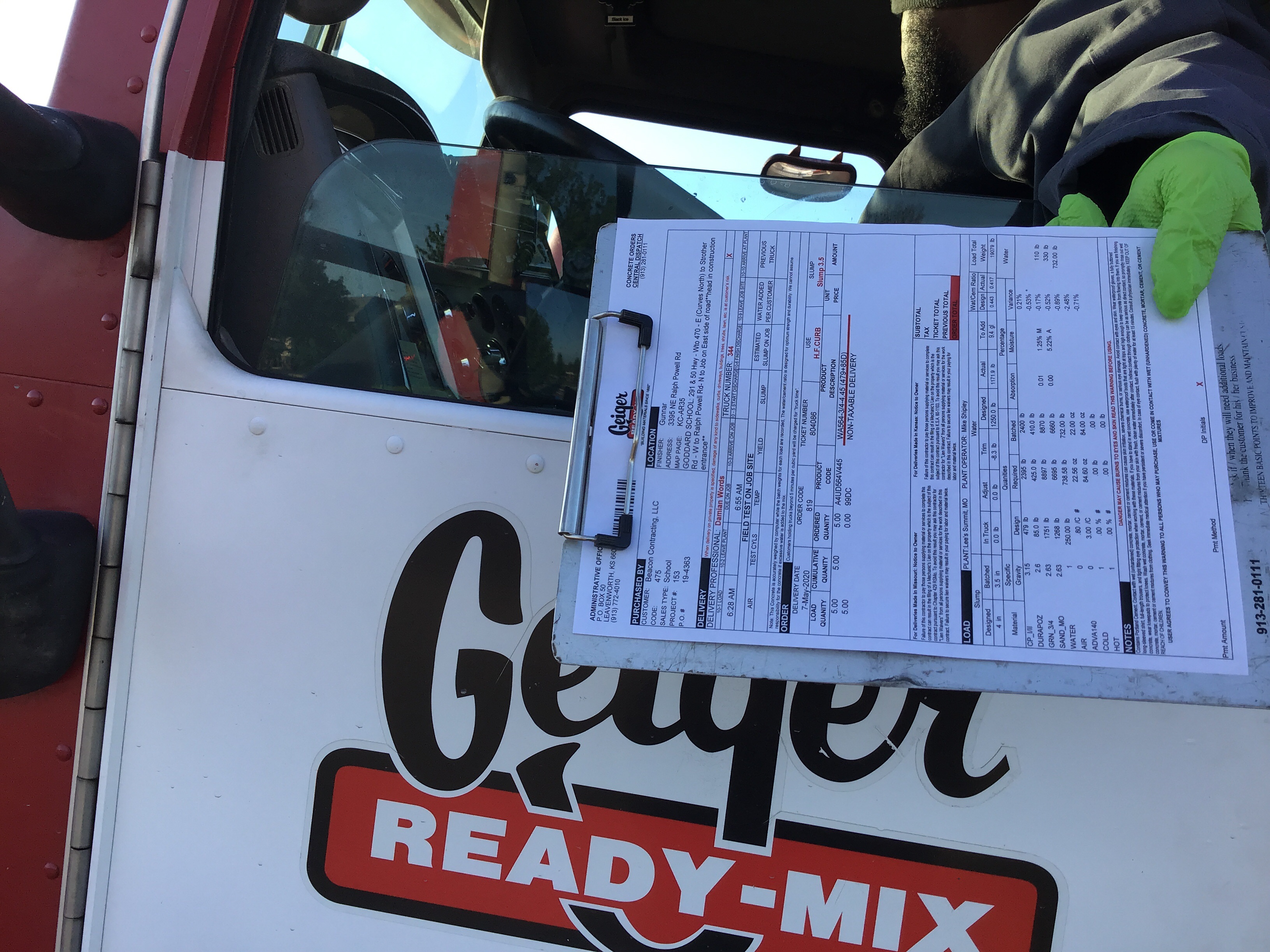

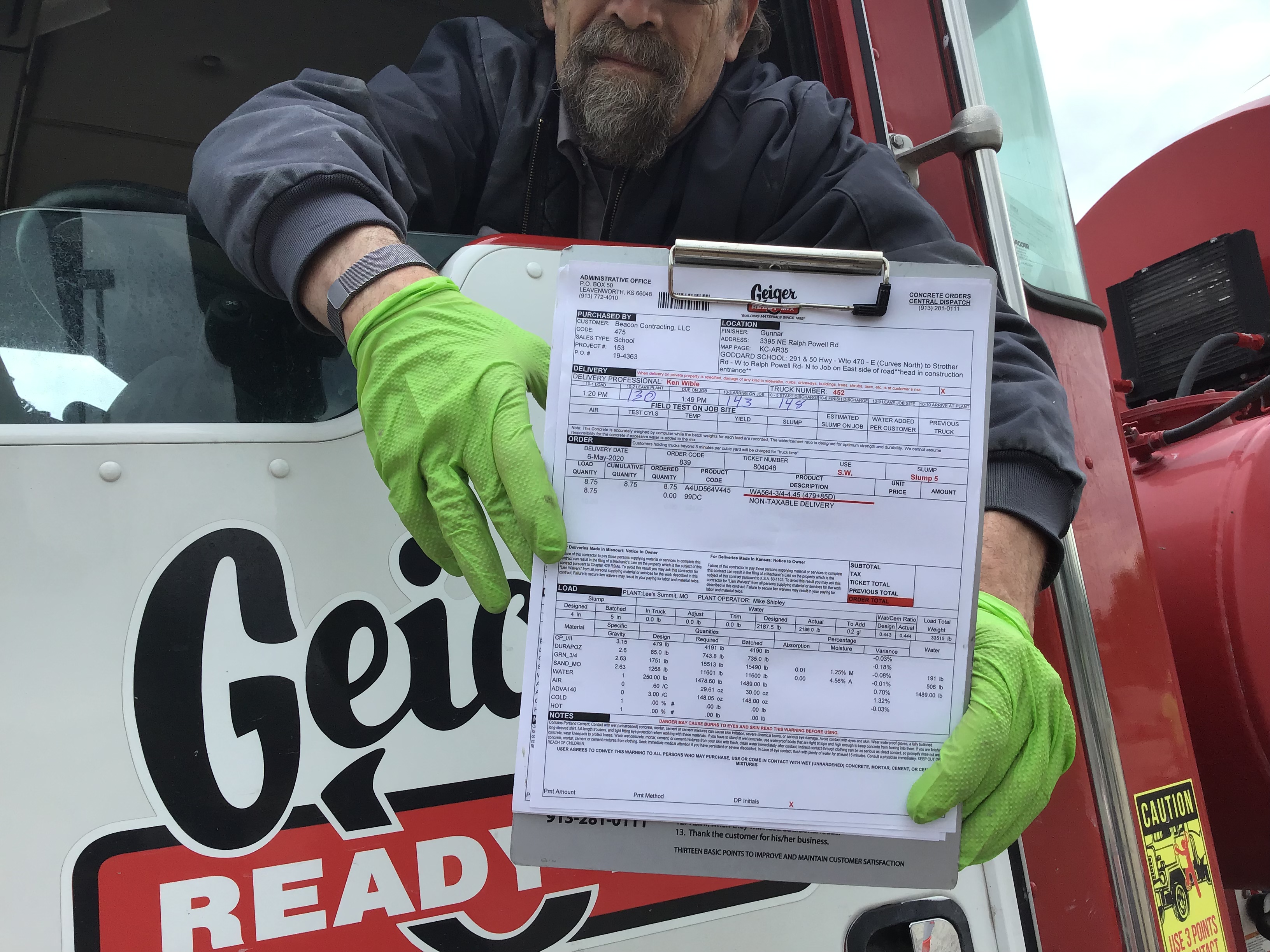

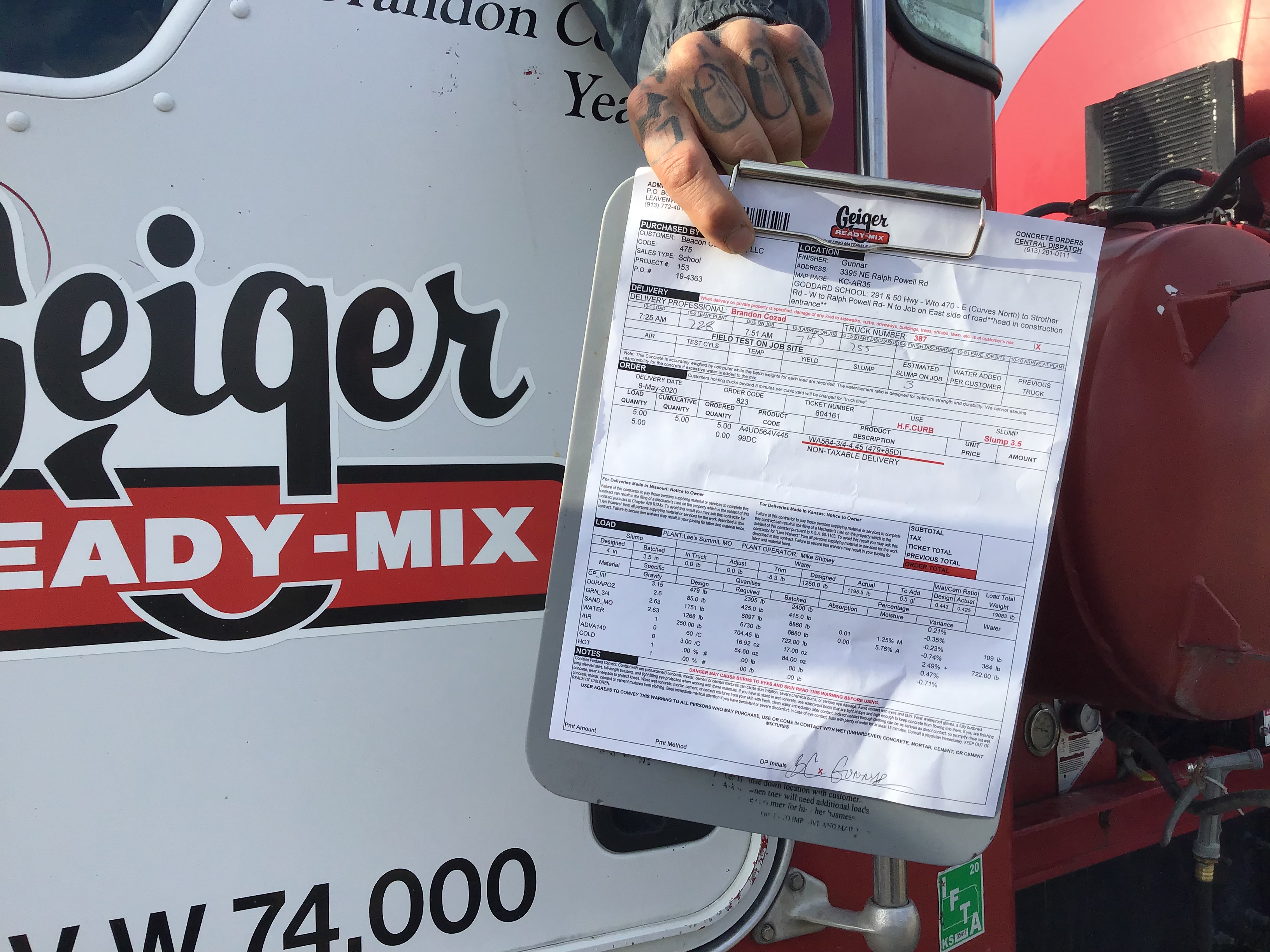

Type 5 was used for Base lift for parking lot. Asphalt temperatures were in range. contractor will email first and last asphalt ticket . 6/8/9 MONDAY
Street - Surface Course Passed 06/09/2020
Misc
Informational
06/09/2020
The Surface Course was completed type 5 was used. Asphalt ticket first and last will be emailed to me. 6/9/20 Tuesday.
Pavement-Curb Construction Passed 06/22/2020
Misc
Corrective Action Required
05/12/2020
Contractor installed approximately 300’ of private curb in lot area. Curbs will require patching due to honey combing in the front and back of curb.I will re-inspect after patching is completed.
Misc
Informational
05/12/2020
Contractor patch and smooth over the honeycombs on the backside of curb 4/21/20.
Misc
Informational
05/12/2020
Contractor poured curb & sidewalk on project. 5/7/20 43 degree Sunny.
Misc
Informational
05/12/2020
Contractor continued to pour curbs on the Westside of parking lot. Temperature at @ 9:50 was 51 degrees rising & sunny.
Misc
Informational
05/12/2020
Contractor poured curbs on the Northside of parking lot.
Pavement-Aggregate Base Passed 06/22/2020
Proof roll parking lot Passed 06/22/2020
Misc
Informational
05/19/2020
Erosion Control Inspection Passed 06/22/2020
Misc
Informational
05/28/2020
Erosion control is still in place.
Fire Line Construction Inspection Passed 06/25/2020
Misc
Informational
09/17/2019
Contractor began construction on Fire Line. 9/17/19
Grading/Excavation/Fill Inspection Passed 11/17/2020
Misc
Informational
07/15/2019
Contractor continued to construct entrance to site and grading .
Misc
Informational
07/15/2019
Continued to excavate and grade site for future installation of utilities . Contractor also placed contractor construction trailer .
Roof Drain Passed 11/17/2020
Misc
Informational
10/30/2019
Contractor installed drain pipes in the ground that run to the 90 deg bend to the roof drains 10/28/19.
Water Line - Construction Inspection Passed 11/17/2020
Misc
Informational
11/21/2019
Tie-in of 6x8 Tee, 6” valve & and relocation of existing Fire Hydarnt . The 90 degree “J” bend was replaced on the existing Fire Hydrant. All fitting have been mega lugged and contractor wrapped all installed DIP pipping with poly wrap. Contractor will fence off excavated area to pour thrust block behind 6”X8” Tee for Goddard School.
Misc
Informational
11/21/2019
Contractor poured thrust block behind 8”X6” Tee that was installed on Saturday 10/19/19.
Misc
Informational
11/21/2019
Contractor began to installed 2” Blue Poly Domestic water main. 11/21/19
Water Line - Coliform Test 1 Passed 11/17/2020
Curb - Proof Roll Passed 11/17/2020
Misc
Informational
05/01/2020
Proof roll passed further testing.
Sidewalk Inspection Passed 11/17/2020
Misc
Informational
05/07/2020
Contractor began to establish subgrade for sidewalk.
Misc
Informational
05/07/2020
Contractor will be pouring public sidewalk today 5/7/20 43 degrees Sunny & rising.
Water Line - Hydrostatic Test Passed 11/17/2020
Water Line - Coliform Test 2 Passed 11/17/2020
Water Line - Coliform Test 1 Passed 11/17/2020
Site Visit Complete 11/17/2020
Misc
Informational
04/24/2020
Contractor not working due to the rainy conditions. 4//24/20
Water Line - Coliform Test 2 Passed 11/17/2020
Documents & Images
Date Uploaded File Type Document Name
06/13/2019 Receipt Receipt for transaction: 2019-003650
06/20/2019 Letter DE-Permit
06/21/2019 DE-Permit Signed
07/02/2019 Letter DE-Daily Inspection Summary
07/08/2019 Letter DE-Daily Inspection Summary
07/08/2019 Letter DE-Daily Inspection Summary
07/08/2019 Letter DE-Daily Inspection Summary
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter DE-Daily Inspection Summary
07/11/2019 Letter INSPECTION SUMMARY
07/15/2019 Letter INSPECTION SUMMARY
08/20/2019 Letter DE-Daily Inspection Summary
08/20/2019 image 6” sanitary
08/20/2019 image backfill 6” sanitary
08/20/2019 Letter INSPECTION SUMMARY
08/20/2019 Letter DE-Daily Inspection Summary
08/29/2019 Letter DE-Daily Inspection Summary
09/09/2019 Letter DE-Daily Inspection Summary
09/09/2019 Letter DE-Daily Inspection Summary
09/09/2019 Letter DE-Daily Inspection Summary
09/09/2019 DE-Daily Inspection Summary_20190909074151
09/17/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
10/19/2019 image 6x8 Tie-in
10/19/2019 Letter INSPECTION SUMMARY
11/14/2019 Letter INSPECTION SUMMARY
11/14/2019 image 1
11/14/2019 image 2
11/14/2019 image 3 valves
11/14/2019 image 4 thrust block
12/12/2019 Letter INSPECTION SUMMARY
12/20/2019 Letter INSPECTION SUMMARY
12/24/2019 Letter INSPECTION SUMMARY
04/07/2020 Letter DE-Daily Inspection Summary
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter DE-Daily Inspection Summary
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter DE-Daily Inspection Summary
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter DE-Daily Inspection Summary
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/23/2020 Letter INSPECTION SUMMARY
04/24/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/06/2020 20
05/06/2020 80A07AD3-B7DF-4589-B8E9-6BC483780103
05/06/2020 Letter INSPECTION SUMMARY
05/07/2020 image
05/07/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY
05/08/2020 AA2E0949-F528-42BF-96EC-CBAF1E5578A6
05/08/2020 70FAF8AA-7BAD-4110-A9E0-13939F370D83
05/08/2020 A0FA0793-319B-480F-82D7-1046406B1269
05/08/2020 Letter INSPECTION SUMMARY
05/08/2020 Letter INSPECTION SUMMARY
05/12/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
06/22/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
06/22/2020 Letter DE-Punch List
06/22/2020 Goddard School Substantial Completion
06/22/2020 Goddard Schoold Punch List
11/17/2020 Letter DE-Certificate of Final Acceptance (Commercial)
11/17/2020 Goddard School Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
