Permit Application Status

PRSUBD20203769


In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary


PRSUBD20203769
Public Infrastructure
Substantial Completion
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
Public sanitary sewer associated with the Village
10/16/2020
08/30/2021
Locations
Contacts
CITY OF LEES SUMMIT, Address:PO BOX 1600
FOGEL-ANDERSON CONSTRUCTION CO, Address:1212 E 8TH ST, Phone:(816) 842-6914
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 10/16/2020 08/20/2021
Mike Weisenborn
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $11,102.40 $11,102.40 Paid 08/20/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 08/25/2021
Misc
Informational
08/25/2021
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2. 8/26/21 Thursday (Clarkson - Darron crew) Contractor has installed the base of MH A-3 241 of 8” PVC SDR-26 was installed from A-2 to A-3. Contractor continued to install sanitary Line A. Most of MH A-1 vertical section were stacked and backfilled. Olsson third party inspection took density test. 9/1/21 Wednesday Clarkson - (Darron crew / Gregg Crew help with stubs) Contractor installed approximately 8” SDR-26 170 from MH A-3 to A-4 8/26 to 8/30 base of A-4 was installed. Tuesday contractor was rained out at 10:30 but installed 42’ of 6” on the service stub by at Sta. 8+63.40. Olsson third party inspection performed density test. 9/2/21 Thursday (Clarkson - Darron crew) Approximately 108’ of 6” to finish service stub at Sta. 8+63.40 poured inverts in A-2 & A-3, 112’ of 8” SDR-26 sewer main between A-1 & D-1 (Looney’ crew) did 2 service stubs between A-3 & A-4 on Wednesday. Today Approximately 68’ of 8” SDR-26 A-1 & D-1, set base section & riser of D-1 then 126 of 8” between D-1 & D-2. 9/7/21 Tuesday (Clarkson - Darron crew) Continued to install sanitary line D will update with approximate footage . 124’ between D-1 & D-2, 42’ between D-2 & D-3 installed base section of D-2 9/8/21 Wednesday Contractor installed approximately 178’ between D-2 & D-3, poured inverts in D-1 & D-2 stacked out MHs & backfilled these MHs 9/9/21 Thursday Contractor installed approximately 205’ of 8” SDR-26 between A-4 & A-5, set MH A-5. 9/14/21 Tuesday (Clarkson - Darron crew) Contractor installed 143’ of 8” PVC SDR-26 from MH A-6 to E-1 9/13/21 Monday. Two laterals 5’ stubs were installed but the ditch checks need to be poured at a later date when the grease traps sanitary lines are installed as-per plan. Today contractor installed 8” sanitary line pass the encasement on line A. 9/15/21 Wednesday (Clarkson - Darron crew) Recap of work performed this week: installed base section riser & cone of E-1, installed 143’ of 8” between A-6 & E-1 for future 2 connections 5’ a piece. Installed 112’ of 8” between A-6 & A-7, tied 20’ of rebar cage for concrete encasement at Sta. 12+76. 9/20/21 Monday (Clarkson - Darron crew) Wednesday-188’ of 8” between A-6 & A-7 set MH A-7 stack out A-7 Thursday - 112’ of 8” between D-3 & D-4. Contractor continued to work on Line D. Today137’ of 8” between D-4 & D-5. 9/21/21 Tuesday (Clarkson - Darron crew) Contractor will be pouring inverts and collars on MHs A-6, D-3,D-4, & D-5. Contractor will stack out D-4 & D-5. 12/01/21 Wednesday Tuesday & Wednesday the sanitary line was tested air, vacuum, & mandrel and passed for lines A,D, & E. 12/06/21 Monday Walk through on sanitary main a small amount of clean up of debris and mastic. I will contact water to perform walk through of sanitary lines A,D, & E.
Sanitary Sewer Construction Inspection Partial 02/07/2022
Misc
Informational
08/25/2021
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
02/07/2022

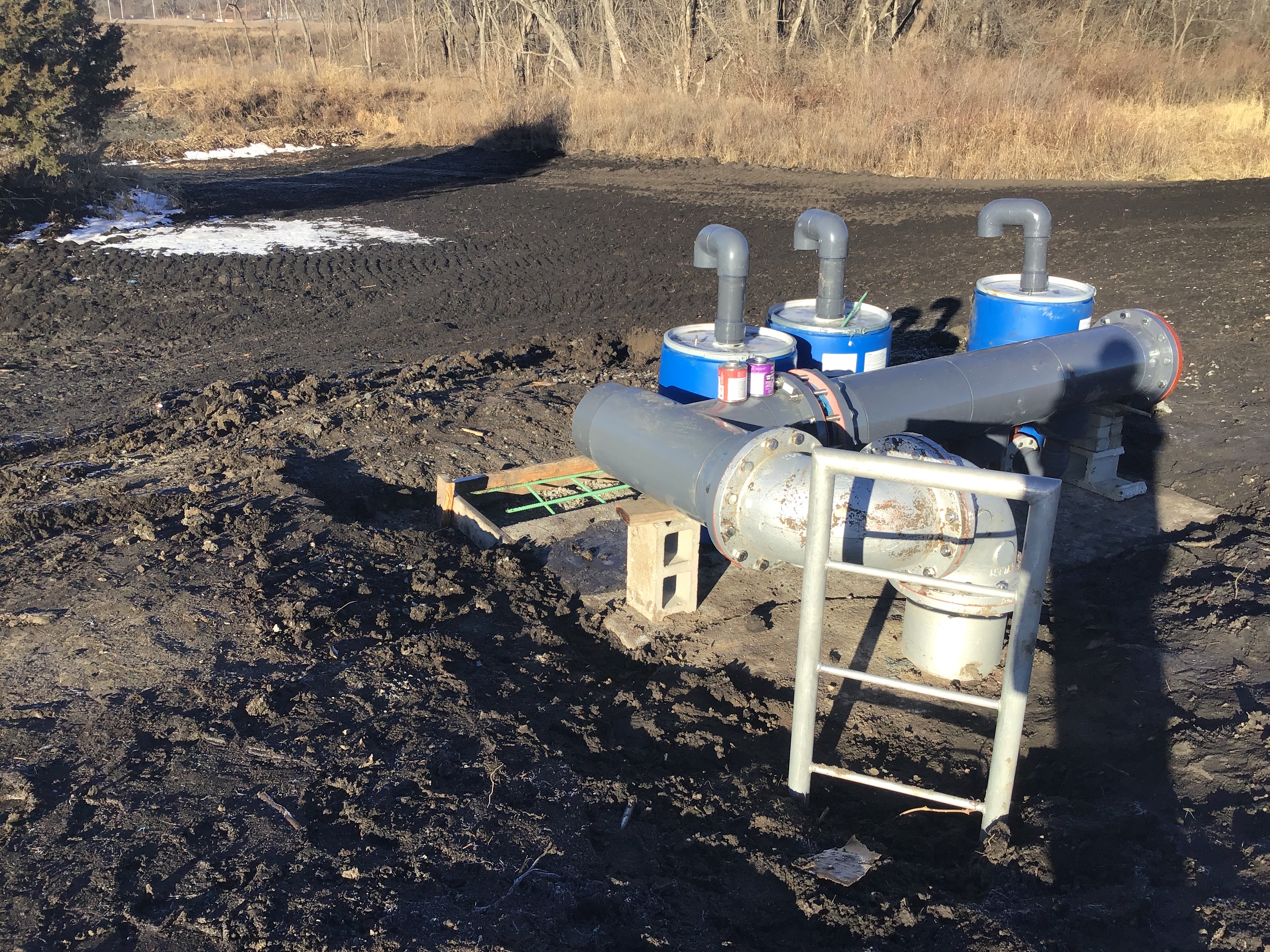

02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge. 02/08/22 Tuesday (Clarkson - Gregg crew) Continued the installation of Sanitary Scrubber.
Sanitary Sewer Construction Inspection Partial 03/15/2023
Misc
Informational
02/07/2022
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
02/07/2022
02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge.
Misc
Informational
03/15/2023
03/15/23 Wednesday ( Clarkson-Gregg Crew ) The contractor installed 56' of 10" SDR 26 from Blue Valley Manhole to existing manhole on line A as per plan.
Sanitary Sewer Construction Inspection Partial 03/15/2023
Misc
Informational
03/15/2023
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
03/15/2023
02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge.
Misc
Informational
03/15/2023
03/15/23 Wednesday JMJ ( Clarkson-Gregg Crew ) The contractor installed 56' of 10" SDR 26 from Blue Valley Manhole to existing manhole on line A as per plan 03/14/23 Tuesday. Contractor installed 21' of 10" SDR 26 into Lee's Summit Manhole sanitary. Contractor poured invert on manholes for Lee's Summit and Blue Valley.
Sanitary Sewer Construction Inspection Partial 3/24/2023 3/24/2023 03/24/2023
Misc
Informational
03/15/2023
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
03/15/2023
02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge.
Misc
Informational
03/15/2023
03/15/23 Wednesday JMJ ( Clarkson-Gregg Crew ) The contractor installed 56' of 10" SDR 26 from Blue Valley Manhole to existing manhole on line A as per plan 03/14/23 Tuesday. Contractor installed 21' of 10" SDR 26 into Lee's Summit Manhole sanitary. Contractor poured invert on manholes for Lee's Summit and Blue Valley. 03/23/23 Thursday JMJ ( Clarkson Const. ) Contractor backfilled sanitary manholes and pipping Olson is the third party testing for compaction. Contractor is buttoning up excavation for the incoming inclement weather 03/24/23. Testing of sanitary line will happen at a future date.
Misc
Informational
04/03/2023
04/03/23 Monday JMJ ( Clarkson Construction ) Contract began the repair to the sanitary low tap were installed, sags on lines, pouring inverts, and grouting all lifting lugs on all MH's.
Site Visit Partial 3/29/2023 3/29/2023 03/29/2023
Misc
Informational
03/29/2023
03/29/23 Wednesday JMJ ( Clarkson Construction CO. ) Contractor was performing general grading of site that was excavated during the installation of sanitary sewer for Blue Valley and the City of Lee's Summit. Also, inspector did a general site inspection of the entire Paragon Star project. .
Sanitary Sewer Construction Inspection Partial 4/5/2023 4/5/2023 04/11/2023
Misc
Informational
03/24/2023
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
03/24/2023
02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge.
Misc
Informational
03/24/2023
03/15/23 Wednesday JMJ ( Clarkson-Gregg Crew ) The contractor installed 56' of 10" SDR 26 from Blue Valley Manhole to existing manhole on line A as per plan 03/14/23 Tuesday. Contractor installed 21' of 10" SDR 26 into Lee's Summit Manhole sanitary. Contractor poured invert on manholes for Lee's Summit and Blue Valley. 03/23/23 Thursday JMJ ( Clarkson Const. ) Contractor backfilled sanitary manholes and pipping Olson is the third party testing for compaction. Contractor is buttoning up excavation for the incoming inclement weather 03/24/23. Testing of sanitary line will happen at a future date. 04/11/23 Tuesday JMJ Clarkson Const. - Ron ) Contractor started completing the punch list last week for the sanitary line fixing Sags, elevation of wyes & pipe on West most portion and pouring inverts. Contractor is pouring invert today.
Sanitary Sewer - Air Test Passed 08/17/2023
MISC
Informational
08/17/2023
The air test for all public sewer installed has passed.
Sanitary Sewer - Mandrel Passed 08/17/2023
PW-Misc
Informational
08/17/2023
The mandrel test for all the public sewer installed has been passed.
Sanitary Sewer - Vacuum Passed 08/17/2023
PW-Misc
Informational
08/17/2023
The vaccuum test for all public sewer has been done and has passed the inspection.
Sanitary Sewer Construction Inspection Passed 6/5/2023 08/17/2023
Misc
Informational
04/11/2023
8/25/21 Wednesday (Clarkson-Darron crew) Contractor installed approximately 132’ of 10” SDR-26 MH A-1 to A-2 from 8/19/21 to 8/24/21. Contractor has set the base for A-1 & A-2. 8” SDR-26 is being installed today from MH A-2.
Misc
Informational
04/11/2023
02/07/22 Monday (Clarkson - Gregg crew) The contractor was installing Sanitary Scrubber as per project plans. The installation of scrubber is on Westside of River Road and North of East bridge.
Misc
Informational
04/11/2023
03/15/23 Wednesday JMJ ( Clarkson-Gregg Crew ) The contractor installed 56' of 10" SDR 26 from Blue Valley Manhole to existing manhole on line A as per plan 03/14/23 Tuesday. Contractor installed 21' of 10" SDR 26 into Lee's Summit Manhole sanitary. Contractor poured invert on manholes for Lee's Summit and Blue Valley. 03/23/23 Thursday JMJ ( Clarkson Const. ) Contractor backfilled sanitary manholes and pipping Olson is the third party testing for compaction. Contractor is buttoning up excavation for the incoming inclement weather 03/24/23. Testing of sanitary line will happen at a future date. 04/11/23 Tuesday JMJ Clarkson Const. - Ron ) Contractor started completing the punch list last week for the sanitary line fixing Sags, elevation of wyes & pipe on West most portion and pouring inverts. Contractor is pouring invert today.
MISC
Informational
08/17/2023
All the sags have been completed and corrected. The camera test was passed and this sanitary has been accepted.
Sanitary Sewer - Camera Test Passed 9/18/2023 08/17/2023
MISC
Informational
08/17/2023
All the sags have been completed and corrected. The camera test was passed and this sanitary has been accepted.
Documents & Images
Date Uploaded File Type Document Name
08/20/2021 Receipt Receipt for transaction:2021-006700
08/24/2021 Approved Plans Paragon Star Public Sanitary Sewer Approved 8.23.21
08/25/2021 image.jpg
08/25/2021 image.jpg0
08/25/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/30/2021 Letter DE-Permit
09/10/2021 MH A-5.jpg
09/10/2021 MH A-6.jpg
09/14/2021 image.jpg1
02/07/2022 Letter INSPECTION SUMMARY
02/08/2022 image.jpg2
02/08/2022 image.jpg3
02/08/2022 image.jpg4
02/08/2022 Letter INSPECTION SUMMARY
02/09/2022 image.jpg5
03/15/2023 Letter INSPECTION SUMMARY
03/15/2023 Letter INSPECTION SUMMARY
03/15/2023 Letter INSPECTION SUMMARY
03/24/2023 Letter INSPECTION SUMMARY
03/29/2023 Letter INSPECTION SUMMARY
04/03/2023 Letter INSPECTION SUMMARY
04/11/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter INSPECTION SUMMARY
08/17/2023 Letter DE-Certificate of Substantial Completion Single Lot
08/17/2023 Paragon Star Offsite -Public Sewer Substantial Completion
08/17/2023 Letter DE-Punch List
08/17/2023 Paragon Star Offsite -Public Sewer Punch List
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
