Summary


PRSUBD20200866
Public Infrastructure
Final Acceptance
SUMMIT VIEW FARMS DEVELOPMENT GROUP LLC
DEVELOPMENT COMPLETE
SUMMIT VIEW FARMS 4TH PLAT - STREET/STORM, SANITARY AND WATER
04/06/2020
03/15/2021
07/31/2023
Locations
Address
2302 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2306 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2310 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2314 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2323 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2319 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2315 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2311 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2307 SW SERENA PL, LEES SUMMIT, MO 64082

Address
2303 SW SERENA PL, LEES SUMMIT, MO 64082

Address
3141 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3137 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3133 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3119 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3115 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3111 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3107 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
2317 SW MORRIS DR, LEES SUMMIT, MO 64082

Address
3108 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3112 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3116 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3120 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3124 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3128 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3132 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3203 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3207 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3211 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3215 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3219 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3223 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3222 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3218 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3214 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3210 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3206 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3202 SW ENOCH ST, LEES SUMMIT, MO 64082

Address
3205 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3209 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3213 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3217 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3221 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3216 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3212 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Address
3204 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Property
69520082100000000

Property
69520082200000000

Property
69520081900000000

Property
69520082300000000

Property
69520082000000000

Property
69520081400000000

Property
69520081500000000

Property
69520081600000000

Property
69520081700000000

Property
69520081800000000

Property
69520081300000000

Property
69520081200000000

Property
69520081100000000

Property
69520081000000000

Property
69520080900000000

Property
69520080800000000

Property
69520080700000000

Property
69520080600000000

Property
69520099600000000

Property
69520099700000000

Property
69520053500000000

Property
69520053600000000

Property
69520053700000000

Property
69520099800000000

Property
69520099900000000

Property
69520090100000000

Property
69520120600000000

Property
69520120500000000

Property
69520120400000000

Property
69520120300000000

Property
69520120200000000

Property
69520120100000000

Property
69520110700000000

Property
69520110600000000

Property
69520110800000000

Property
69520110500000000

Property
69520110900000000

Property
69520110400000000

Property
69520111000000000

Property
69520110300000000

Property
69520111100000000

Property
69520110200000000

Property
69520110100000000

Property
69520109700000000

Property
69520109800000000

Property
69520109900000000

Property
69520100100000000

Address
3104 SW SUMMIT VIEW TRL, LEES SUMMIT, MO 64082

Address
3208 SW SADDLEBRED TER, LEES SUMMIT, MO 64082

Contacts
LAMP RYNEARSON, Address:9001 STATE LINE RD STE 200, Phone:(402) 496-2498
REDFORD CONSTRUCTION INC, Address:PO BOX 1065, Phone:(816) 540-2030
SUMMIT VIEW FARMS DEVELOPMENT GROUP LLC, Address:13450 E STATE ROUTE 150
BURGSTAHLER JOEL & JANNA, Address:3104 SW SUMMIT VIEW TRL
PETERSON TRUST DATED 05/22/2024, Address:3108 SW SUMMIT VIEW TRL
SPELLERBERG ENTERPRISES LLC, Address:613 NE VIEWPARK DR
WOOD BROTHERS CONSTRUCTION INC, Address:512 NE LYNDONWOOD DR
KELLY DEDERICK D, Address:3120 SW SUMMIT VIEW TRL
HARDT DANIEL, Address:3124 SW SUMMIT VIEW TRL
CORDELL BRIAN & AMBER, Address:3128 SW SUMMIT VIEW TRL
SUMMIT VIEW FARMS HOME OWNERS ASSOCIATION LLC, Address:PO BOX 291
WALKER CUSTOM HOMES LLC, Address:PO BOX 247
WELSH ERNEST E & DONNA L, Address:3107 SW SUMMIT VIEW TRL
JW THOMAS LLC, Address:14706 S HUTT RD
BILL KENNEY HOMES INC, Address:13450 E STATE ROUTE 150 HWY
WOODS BROTHERS CONSTRUCTION INC, Address:512 NE LYNDONWOOD DR
PEMBRICK ALFRED G JR & SHANNON, Address:2306 SW SERENA PL
NZC HOMES LLC, Address:1009 INDUSTRIAL DR
SHEDD KEVIN C & KATHERINE E, Address:2311 SW SERENA PL
STEWART BUILDERS LLC, Address:12 SEQUOYAH PT
COON JEREMY & MICHELLE, Address:2323 SW SERENA PL
FOSTER SHANE A & POLLY A, Address:3219 SW ENOCH ST
RUDMAN SHANE A & MINKA A, Address:3223 SW ENOCH ST
SWAIN JON P & CARALYNN M, Address:3202 SW ENOCH ST
MCCOMBS ALVIN & VERLANA, Address:3206 SW ENOCH ST
FINNEGAN LISA M, Address:3210 SW ENOCH ST
THORESON NATHAN R & HEATHER B, Address:3214 SW ENOCH ST
HELLER MARK, Address:3218 SW ENOCH ST
ENECHUKWU DILIBE, Address:3213 SW SADDLEBRED TER
O'NEAL STACIE, Address:3204 SW SADDLEBRED TER
WEBB AMY L, Address:3208 SW LAURA CRT
SANDERS STEPHEN & CINDY, Address:3212 SW SADDLEBRED TER
HILL DANIEL S & ASHLEY E, Address:3208 SW SADDLEBRED TER
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 04/06/2020 03/15/2021
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
9110068-Storm Sewer Inspection Fee $7,579.95 $7,579.95 Paid 03/10/2021
9110081-Paved Surface Inspection Fee $16,766.76 $16,766.76 Paid 03/10/2021
9110071-Site Grading Fee $4,786.05 $4,786.05 Paid 03/10/2021
91100C8-Sanitary Sewer Insp Fees $7,202.25 $7,202.25 Paid 03/10/2021
91100C9-Water Insp Fee $4,160.79 $4,160.79 Paid 03/10/2021
9110072-Water Test Fee $600.00 $600.00 Paid 03/10/2021
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.


$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 5/25/2021 05/25/2021
Misc
Informational

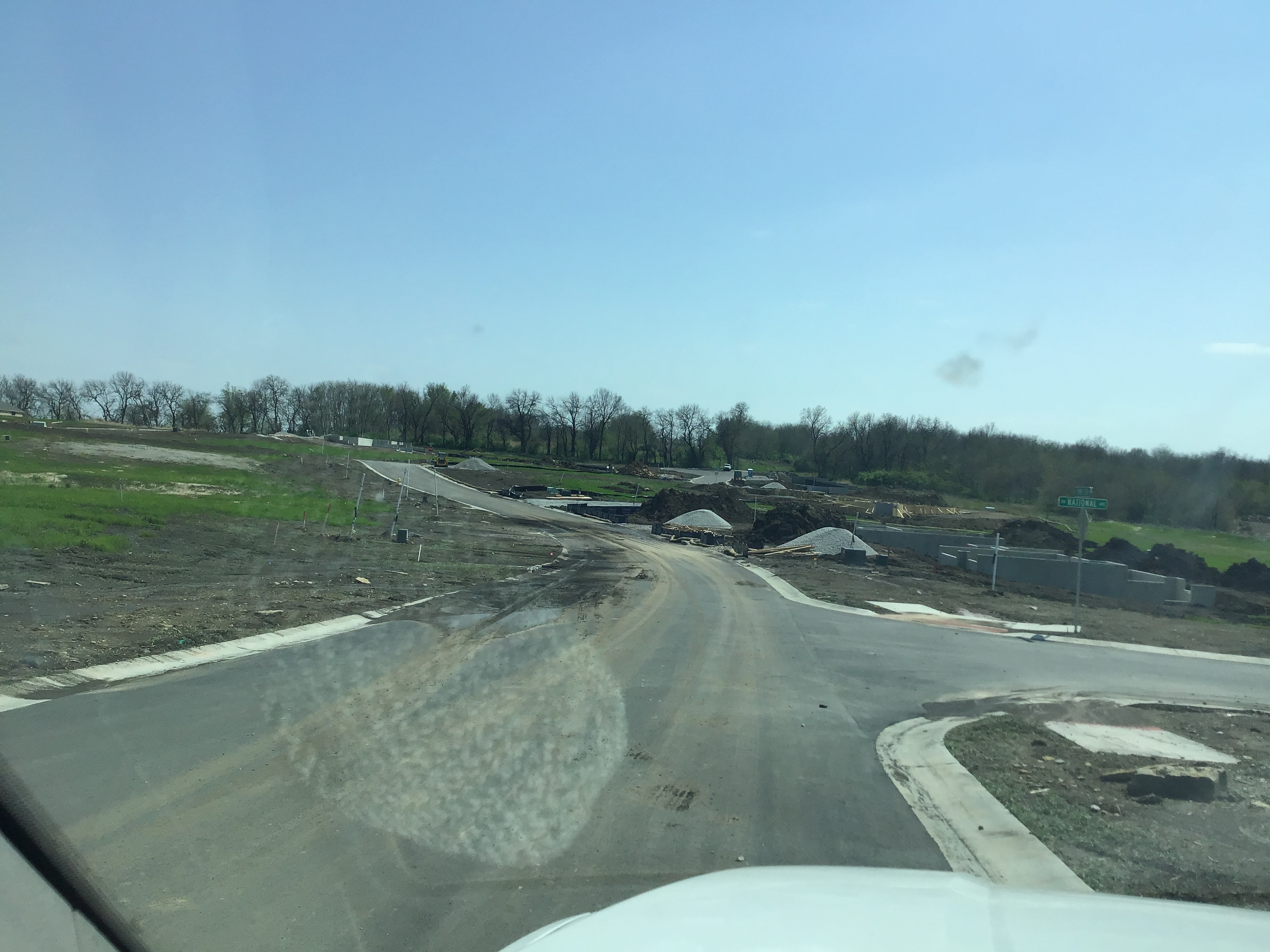

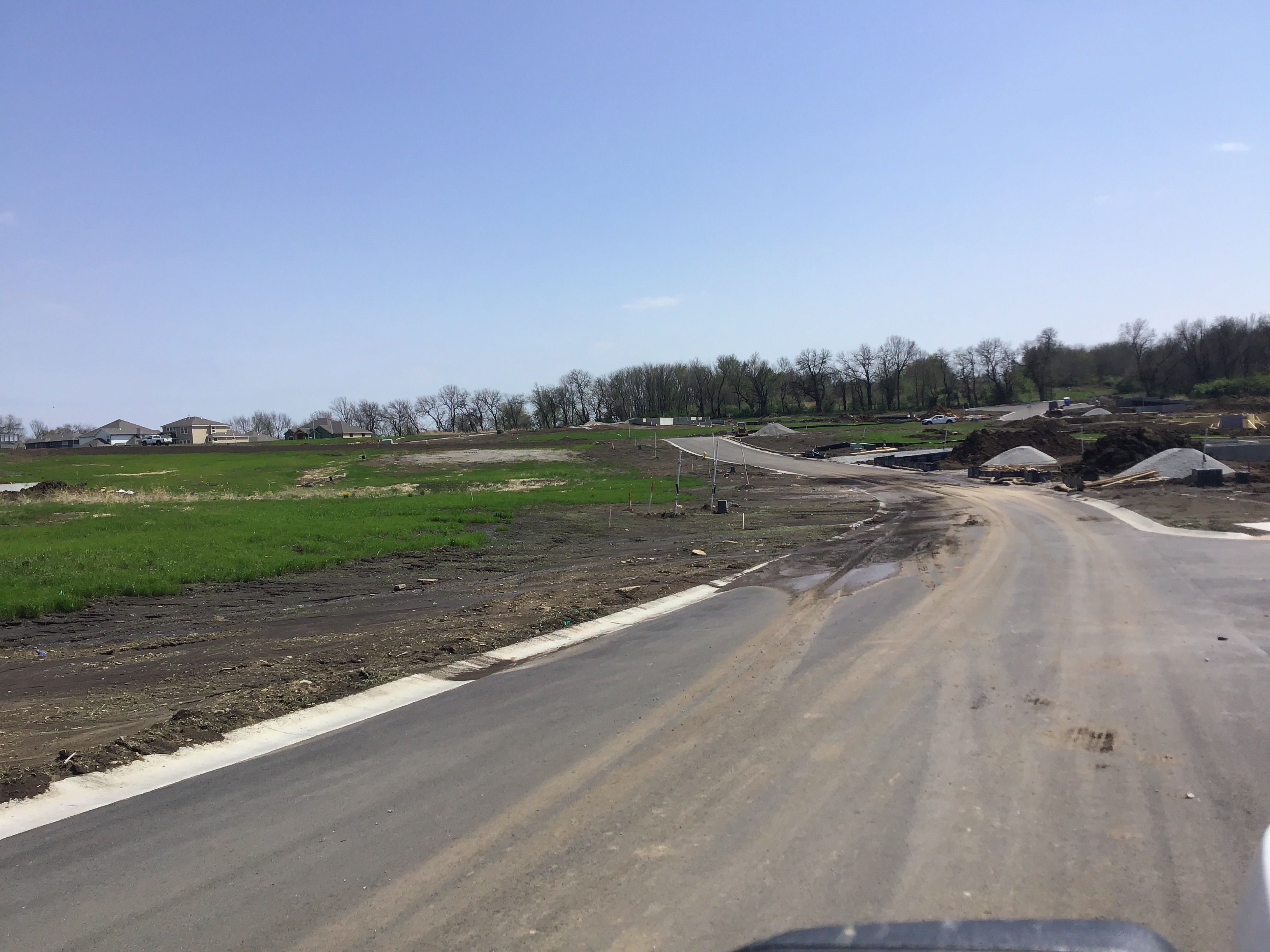

05/25/2021
Redford is starting on the Kasas City side of the project. They will be dropping a MH in Kansas City Main . We are not inspecting this , we are just observing. We willl be inspecting when they get to the Lee's Summit side MH 4 -A-2
Sanitary Sewer Construction Inspection Partial 5/26/2021 05/26/2021
Misc
Informational
05/26/2021
5-26-21
Sanitary Sewer Construction Inspection Partial 5/26/2021 5/26/2021 05/26/2021
Misc
Informational
05/26/2021
5-26-21 Sanitary line will be getting installed today.
Sanitary Sewer Construction Inspection Partial 5/28/2021 5/28/2021 05/28/2021
Misc
Informational
05/26/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
05/28/2021
5-28-21: No work going on due to the rain on 5-27-21
Storm Sewer Construction Inspection Partial 6/1/2021 6/1/2021 06/01/2021
Misc
Informational
06/01/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Sanitary Sewer Construction Inspection Partial 6/2/2021 6/2/2021 06/02/2021
Misc
Informational
05/28/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
05/28/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/02/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Sanitary Sewer Construction Inspection Partial 6/3/2021 6/3/2021 06/03/2021
Misc
Informational
06/02/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/02/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/02/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/03/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Sanitary Sewer Construction Inspection Partial 6/4/2021 6/4/2021 06/04/2021
Misc
Informational
06/03/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/03/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/03/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/03/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/04/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Sanitary Sewer Construction Inspection Partial 6/7/2021 6/7/2021 06/07/2021
Misc
Informational
06/04/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/04/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/04/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/04/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/04/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/07/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Sanitary Sewer Construction Inspection Partial 6/8/2021 6/8/2021 06/08/2021
Misc
Informational
06/07/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/07/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/07/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/07/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/07/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/07/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/08/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Sanitary Sewer Construction Inspection Partial 6/9/2021 6/9/2021 06/09/2021
Misc
Informational
06/08/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/08/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/08/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/08/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/08/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/08/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/08/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/09/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Sanitary Sewer Construction Inspection Partial 6/10/2021 6/10/2021 06/10/2021
Misc
Informational
06/09/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/09/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/09/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/09/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/09/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/09/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/09/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/09/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/10/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Sanitary Sewer Construction Inspection Partial 6/14/2021 6/14/2021 06/14/2021
Misc
Informational
06/10/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/10/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/10/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/10/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/10/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/10/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/10/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/10/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/10/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/14/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Sanitary Sewer Construction Inspection Partial 6/16/2021 6/16/2021 06/16/2021
Misc
Informational
06/14/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/14/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/14/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/14/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/14/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/14/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/14/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/14/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/14/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/14/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
06/16/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Sanitary Sewer Construction Inspection Partial 6/17/2021 6/17/2021 06/17/2021
Misc
Informational
06/16/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/16/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/16/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/16/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/16/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/16/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/16/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/16/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/16/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/16/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
06/16/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
06/17/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Sanitary Sewer Construction Inspection Partial 6/21/2021 6/21/2021 06/21/2021
Misc
Informational
06/17/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/17/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/17/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/17/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/17/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/17/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/17/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/17/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/17/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/17/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
06/17/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
06/17/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
06/21/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Sanitary Sewer Construction Inspection Partial 6/23/2021 6/23/2021 06/23/2021
Misc
Informational
06/21/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/21/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/21/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/21/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/21/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/21/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/21/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/21/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/21/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/21/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
06/21/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
06/21/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
06/21/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Misc
Informational
06/23/2021
6/22/21 9:00- Crew is still working on the service lines on Saddlebred Ter, flowfill should be in for the trench checks around 12:30 today. 14:30- Trench checks placed, crew is currently back filling. 6/23/21 9:50- Service lines have been back filled for Saddlebred Ter, crew has placed MH 4-C1 and is currently working towards MH 4-C2. 14:00- Crew is placing MH 4-C2 and will be starting to work out of it to MH 4-C3. Due to the sanitary being at 1% fall crew is tamping rock before the pipe and also tamping the rock cover after the pipe. Foreman also informed me that they are waiting on cones for the MH’s.
Sanitary Sewer Construction Inspection Partial 7/7/2021 7/7/2021 07/07/2021
Misc
Informational
06/23/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
06/23/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
06/23/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
06/23/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
06/23/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
06/23/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
06/23/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
06/23/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
06/23/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
06/23/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
06/23/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
06/23/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
06/23/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Misc
Informational
06/23/2021
6/22/21 9:00- Crew is still working on the service lines on Saddlebred Ter, flowfill should be in for the trench checks around 12:30 today. 14:30- Trench checks placed, crew is currently back filling. 6/23/21 9:50- Service lines have been back filled for Saddlebred Ter, crew has placed MH 4-C1 and is currently working towards MH 4-C2. 14:00- Crew is placing MH 4-C2 and will be starting to work out of it to MH 4-C3. Due to the sanitary being at 1% fall crew is tamping rock before the pipe and also tamping the rock cover after the pipe. Foreman also informed me that they are waiting on cones for the MH’s.
Misc
Informational
07/07/2021
6/24/21- Foreman sent me a text to let me know that they aren’t working today due to the rain. 6/28/21 8:50- Crew is currently placing cones on the MH’s. Crew left for the day due to rain. 6/29/21 6:30- Crew sent me a text letting me know that they aren’t working today due to the rain. 6/30/21 7:30- Crew texted me letting me know no work due to weather. 7/1/21 7:00- No work for the rest of the week due to weather. 7/7/21 14:00- Crew installed pipe between MH 4C-2 to MH 4C-3. If weather allows they will be installing the service lines.
Sanitary Sewer Construction Inspection Partial 7/8/2021 7/8/2021 07/08/2021
Misc
Informational
07/07/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
07/07/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
07/07/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
07/07/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
07/07/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
07/07/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
07/07/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
07/07/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
07/07/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
07/07/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
07/07/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
07/07/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
07/07/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Misc
Informational
07/07/2021
6/22/21 9:00- Crew is still working on the service lines on Saddlebred Ter, flowfill should be in for the trench checks around 12:30 today. 14:30- Trench checks placed, crew is currently back filling. 6/23/21 9:50- Service lines have been back filled for Saddlebred Ter, crew has placed MH 4-C1 and is currently working towards MH 4-C2. 14:00- Crew is placing MH 4-C2 and will be starting to work out of it to MH 4-C3. Due to the sanitary being at 1% fall crew is tamping rock before the pipe and also tamping the rock cover after the pipe. Foreman also informed me that they are waiting on cones for the MH’s.
Misc
Informational
07/07/2021
6/24/21- Foreman sent me a text to let me know that they aren’t working today due to the rain. 6/28/21 8:50- Crew is currently placing cones on the MH’s. Crew left for the day due to rain. 6/29/21 6:30- Crew sent me a text letting me know that they aren’t working today due to the rain. 6/30/21 7:30- Crew texted me letting me know no work due to weather. 7/1/21 7:00- No work for the rest of the week due to weather. 7/7/21 14:00- Crew installed pipe between MH 4C-2 to MH 4C-3. If weather allows they will be installing the service lines.
Misc
Informational
07/08/2021
7/8/21 9:00- Crew is installing service lines for lots 77, 76. 13:35 Crew has dug out the service lines for lots 75, 81, 80 and is currently working on laying pipe out of MH 4-C3 MH 4-C4. Trench checks will be poured tomorrow morning around 7AM.
Sanitary Sewer Construction Inspection Partial 7/14/2021 7/14/2021 07/14/2021
Misc
Informational
07/08/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
07/08/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
07/08/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
07/08/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
07/08/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
07/08/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
07/08/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
07/08/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
07/08/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
07/08/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
07/08/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
07/08/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
07/08/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Misc
Informational
07/08/2021
6/22/21 9:00- Crew is still working on the service lines on Saddlebred Ter, flowfill should be in for the trench checks around 12:30 today. 14:30- Trench checks placed, crew is currently back filling. 6/23/21 9:50- Service lines have been back filled for Saddlebred Ter, crew has placed MH 4-C1 and is currently working towards MH 4-C2. 14:00- Crew is placing MH 4-C2 and will be starting to work out of it to MH 4-C3. Due to the sanitary being at 1% fall crew is tamping rock before the pipe and also tamping the rock cover after the pipe. Foreman also informed me that they are waiting on cones for the MH’s.
Misc
Informational
07/08/2021
6/24/21- Foreman sent me a text to let me know that they aren’t working today due to the rain. 6/28/21 8:50- Crew is currently placing cones on the MH’s. Crew left for the day due to rain. 6/29/21 6:30- Crew sent me a text letting me know that they aren’t working today due to the rain. 6/30/21 7:30- Crew texted me letting me know no work due to weather. 7/1/21 7:00- No work for the rest of the week due to weather. 7/7/21 14:00- Crew installed pipe between MH 4C-2 to MH 4C-3. If weather allows they will be installing the service lines.
Misc
Informational
07/08/2021
7/8/21 9:00- Crew is installing service lines for lots 77, 76. 13:35 Crew has dug out the service lines for lots 75, 81, 80 and is currently working on laying pipe out of MH 4-C3 MH 4-C4. Trench checks will be poured tomorrow morning around 7AM.
Misc
Informational
07/09/2021
7/9/21 9:00- Crew placed trench checks for the lots on Serena Pl, now back filling and getting ready for the rain this weekend.
Misc
Informational
07/12/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/12/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/12/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/13/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/14/2021
7/13/21 14:00- Crew is moving storm boxes into place on the KCMO side. MH-C4 cone was hit during the back fill process and will need to be replaced. 7/14/21 14:00- Spoke to the foreman about putting everything on the 30 day wait time to start the testing other than MH-C4 that one will be put on the 30 day wait period when the new cone comes in and replaces the cracked one and they get everything sealed back up.
Misc
Informational
07/14/2021
7/13/21 14:00- Crew is moving storm boxes into place on the KCMO side. MH-C4 cone was hit during the back fill process and will need to be replaced. 7/14/21 14:00- Spoke to the foreman about putting everything on the 30 day wait time to start the testing other than MH-C4 that one will be put on the 30 day wait period when the new cone comes in and replaces the cracked one and they get everything sealed back up.
Storm Sewer Construction Inspection Partial 7/27/2021 7/27/2021 07/27/2021
Misc
Informational
07/23/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
07/27/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Storm Sewer Construction Inspection Partial 7/29/2021 7/29/2021 07/29/2021
Misc
Informational
07/27/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
07/27/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
07/29/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Storm Sewer Construction Inspection Partial 7/30/2021 7/30/2021 07/30/2021
Misc
Informational
07/29/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
07/29/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
07/29/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
07/30/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Storm Sewer Construction Inspection Partial 8/3/2021 8/3/2021 08/03/2021
Misc
Informational
07/30/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
07/30/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
07/30/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
07/30/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Misc
Informational
08/03/2021
8/2/21 9:40 - Digging out for JB 4-13B, and CI 4-10C. Should have those boxes later today. 8/3/21 7:30 - Yesterday evening the crew installed 56.88 LF of 30” HDPE between FI 4-10F and FI 4-10G. This morning they placed CI 4-10C and put in 109.08 LF of 42” HDPE between CI 4-10C to CI 4-10D.
Storm Sewer Construction Inspection Partial 8/4/2021 8/4/2021 08/04/2021
Misc
Informational
08/03/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
08/03/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
08/03/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
08/03/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Misc
Informational
08/03/2021
8/2/21 9:40 - Digging out for JB 4-13B, and CI 4-10C. Should have those boxes later today. 8/3/21 7:30 - Yesterday evening the crew installed 56.88 LF of 30” HDPE between FI 4-10F and FI 4-10G. This morning they placed CI 4-10C and put in 109.08 LF of 42” HDPE between CI 4-10C to CI 4-10D.
Misc
Informational
08/04/2021
8/4/21 10:30- Yesterday to this morning the crew installed 42.47LF of 24” HDPE from JB 4-13B to MH 4-HDS1. Also installed 15.94LF of 24” HDPE from MH 4-HDS1 to CI 4-13C. Also installed CI 4-14A and 42.50LF of 15” RCP between CI 4-14A to CI 4-13C. 14:00 - Crew has installed 131.86LF of 18” HDPE from CI 4-13C to CI 4-13D, installed CI 4-13D and then installed 34.25LF of 18” HDPE to CI 4-13E and then installed CI 4-13E.
Storm Sewer Construction Inspection Partial 8/10/2021 8/10/2021 08/10/2021
Misc
Informational
08/04/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
08/04/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
08/04/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
08/04/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Misc
Informational
08/04/2021
8/2/21 9:40 - Digging out for JB 4-13B, and CI 4-10C. Should have those boxes later today. 8/3/21 7:30 - Yesterday evening the crew installed 56.88 LF of 30” HDPE between FI 4-10F and FI 4-10G. This morning they placed CI 4-10C and put in 109.08 LF of 42” HDPE between CI 4-10C to CI 4-10D.
Misc
Informational
08/04/2021
8/4/21 10:30- Yesterday to this morning the crew installed 42.47LF of 24” HDPE from JB 4-13B to MH 4-HDS1. Also installed 15.94LF of 24” HDPE from MH 4-HDS1 to CI 4-13C. Also installed CI 4-14A and 42.50LF of 15” RCP between CI 4-14A to CI 4-13C. 14:00 - Crew has installed 131.86LF of 18” HDPE from CI 4-13C to CI 4-13D, installed CI 4-13D and then installed 34.25LF of 18” HDPE to CI 4-13E and then installed CI 4-13E.
Misc
Informational
08/10/2021
Last Thursday and Friday crew installed 195.1 LF of 15” HDPE and also installed CI 4-13E, CI 4-13F, and CI 4-13G. Crew also installed on last week and Monday STM line 4-15 and STM line 4-15. They informed me that all the storm infrastructure is in but two boxes. Crew also poured inverts on Friday and Monday.
Water Line - Construction Inspection Partial 8/11/2021 8/11/2021 08/11/2021
Misc
Informational
08/11/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Water Line - Construction Inspection Partial 8/16/2021 8/16/2021 08/16/2021
Misc
Informational
08/16/2021
8/16/21 - Placed 150 feet of 8” water line on Enoch St.
Water Line - Construction Inspection Partial 8/17/2021 8/17/2021 08/17/2021
Misc
Informational
08/16/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
08/17/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Sanitary Sewer - Air Test Passed 8/26/2021 8/26/2021 08/26/2021
Misc
Informational
08/26/2021
Line between MH 4-C4 to MH 4-C3 4psi for 2 min= PASS, line between MH 4-C3 to MH 4-C2 4psi for 2 min= PASS, line between MH 4-C2 to MH 4-C1 4psi for 2 min= PASS, MH 4-C1 to MH 4-A2 4psi for 2 min= PASS, MH 4-A2 to MH 4-B1 4 psi for 2 min = PASS, line between MH 4-A2 to MH 4-A1 4 psi for 2 min = PASS, line between MH 4-A2 to MH 4-A3 = FAIL ( Retested 8/26/21 after finding rock between the service lines retest and it PASSED), line between MH 4-A3 to MH 4-A4 4 psi for 2 min = PASS, line between MH 4-A4 to MH 4-A5 4 psi for 2 min = PASS, line between MH 4-A5 to MH 4-D1 4 psi for 2 min = PASS, line between MH 4-D1 TO MH 4-D2 4 psi for 2 min = PASS, line between MH 4-D2 to MH 4-D3 4 psi for 2 min = PASS, line between MH4-A5 to MH4-A6 4 psi for 2 min = PASS, line between MH 4-A6 to MH 4-A7 4 psi for 2 min = PASS, line between MH 4-A7 to MH 4-A8 4 psi 2 min = PASS, MH 4-A8 to MH 4-A9 4 psi for 2 min = PASS
Sanitary Sewer - Mandrel Passed 8/26/2021 8/26/2021 08/26/2021
Misc
Informational
08/26/2021
8/26/21 9:00 - Crew started the test around 6:30 this morning and had no issues, test passed.
Sanitary Sewer - Vacuum Passed 8/26/2021 8/26/2021 08/26/2021
Misc
Informational
08/26/2021
MH 4-C4 10 psi 4 min= PASS, MH 4-C3 10 psi 4 min= PASS, MH 4-C2 10 psi 4 min= PASS, MH 4-C1 10 psi 4 min=PASS, MH 4-A2 = FAIL ( Retested 8/26/21 PASSED ), MH 4-B1 10 psi 4 min = PASS, MH 4-A1 10 psi 4 min = PASS, MH 4-A3 10 psi 4 min = PASS, MH 4-A4 10 psi 4 min = FAIL ( Retest 8/25/21 PASSED ), MH 4-A5 10 psi 4 min = PASS, MH 4-D1 10 psi 4 min = PASS, MH 4-D2 10 psi 4 min = PASS, MH 4-D3 10 psi 4 min = PASS, MH 4-A6 10 psi 4 min = PASS, MH 4-A7 10 psi 4 min = PASS, MH 4-A8 10 psi 4 min = PASS, MH 4-A9 10 psi 4 min = PASS
Water Line - Construction Inspection Partial 8/26/2021 8/26/2021 08/26/2021
Misc
Informational
08/19/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
08/19/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Misc
Informational
08/19/2021
8/18/21 - Roughly 400 ft of 8in water line was installed down Summit View Trail. 8/19/21 - Roughly 200 ft of 8in water line was installed down Summit View Trail, rest of the day was spent back filling.
Misc
Informational
08/25/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/25/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/26/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/26/2021
8/26/21 15:00 - Crew laid roughly 250 ft of 8in pvc up Saddlebred Terr, started laying 6in pvc on Serena Pl, and installed thrust blocks on the 22.5 and 45’s.
Misc
Informational
02/08/2022
On Monday 1.31.2022 Based on the Water Bond Inspection Redford collected water samples from waterlines in Serena Place and Enoch St for coliform testing. On Tuesday 2.1.2022 Two water samples were collected and submitted to Keystone Labs. Wednesday 2.2.2022 Both samples in Serena Place passed however only one sample passed in Enoch St. Redford will flush line in Enoch St on 2.7.2022 and collect another sample on 2.9.2022.
Water Line - Hydrostatic Test Passed 9/2/2021 9/2/2021 09/02/2021
Misc
Informational
09/02/2021
9/2/21 8:30 - Started testing on 8” line at 8:30 on hydrant STA 5+61.66 sitting at 150 psi = PASSED 11:15 - Started testing on 6” line on hydrant 3+95.83 sitting at 150 psi = PASSED Plan to walk the water and sanitary laterals with the locator next week.
Site Visit Partial 9/9/2021 9/9/2021 09/09/2021
Misc
Informational
09/09/2021
Chlorinating water lines. 9-9-21 9:20. Started Chlorination of 6in line and 8in line at 8:15 10:37 Walked tracer wire on water lines. Tracer wire passed.
Misc
Informational
02/10/2022
On Thursday 2.10.2022 Spire utility company was on site. No other construction activity.
Misc
Informational
02/11/2022
On Friday 2.11.2021 Spire Energy was on site
Water Line - Coliform Test 1 Passed 9/16/2021 (8:00) 9/16/2021 09/16/2021
Water Line - Coliform Test 2 Passed 9/16/2021 9/16/2021 09/16/2021
Grading/Excavation/Fill Inspection Partial 09/23/2021
Misc
Informational
09/23/2021
On Thursday 9/23/2021 The contractor, Randy Spaulding, resumed mass grading in various locations throughout project site. On Wednesday 9/22/2021 I observed mass grading in various locations throughout project site. On Tuesday 9/21/2021 I observed The contractor continuing mass grading in various locations throughout the project site. On Monday 9/20/2021 I observed contractor Randy Spaulding mass grading in various locations throughout the project site. On Wednesday 9/29/2021 I observed contractor Randy Spalding mass grading in various locations. Lamp & Rynearson was surveying on the site. Steve Robbins requested Water conduct a camera inspection of the sanitary line. On Friday October 1, 2021 Contractor, Randy Spalding Excavating INC. mass grading in various locations. Lamp & Rynearson, surveyors were on site.
Pavement-Proof Roll Passed 10/19/2021
Misc
Informational
10/19/2021
On 10/18/2021 I observed contractor, Randy Spalding Excavation conduct a proof roll. The contractor agreed to excavating and adding rock to strengthen the depressed areas throughout the project site. On 10/19/2021 I observed the contractor hauling in rock to various areas throughout the project site. On Thursday, 11-11-2021 I preformed a sub-base proof roll for that passed roadway compaction for placement of asphalt base coarse with Spalding Excavating.
Pavement-Surface Passed 11/12/2021
Misc
Informational
11/12/2021
On Friday, 11-12-2021. Superior / Bowen Asphalt placed the 1st lift of base asphalt on project. Temp. Where around 38 degree’s. On Monday, 11-15-2021. Superior/Bowen Asphalt placed final surface lift of asphalt on project completing asphalt surface. On Wednesday 11/24/2021 JV Concrete installed handicap ramps throughout the project site.
Water Line - Construction Inspection Passed 9/7/2021 9/7/2021 01/19/2022
Misc
Informational
09/01/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
09/01/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Misc
Informational
09/01/2021
8/18/21 - Roughly 400 ft of 8in water line was installed down Summit View Trail. 8/19/21 - Roughly 200 ft of 8in water line was installed down Summit View Trail, rest of the day was spent back filling.
Misc
Informational
09/01/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
09/01/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
09/01/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
09/01/2021
8/26/21 15:00 - Crew laid roughly 250 ft of 8in pvc up Saddlebred Terr, started laying 6in pvc on Serena Pl, and installed thrust blocks on the 22.5 and 45’s.
Misc
Informational
09/01/2021
8/27/21 9:40 - Crew is cleaning up the site for the weekend, back filling, setting up esc around boxes. Asked to place orange fencing around open holes. Yesterday they got half the 6in pvc installed.
Misc
Informational
09/01/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
09/01/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
09/01/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
09/01/2021
9/1/21 9:40 - Crew poured kickers yesterday after the rain passed. Waiting to start the water line testing.
Misc
Informational
09/07/2021
9/7/21 9:30 - Checked to make sure the construction taps was put into place, plan to start cholorination on Thursday.
Sanitary Sewer Construction Inspection Passed 8/12/2021 8/12/2021 01/19/2022
Misc
Informational
07/14/2021
5-26-21 Sanitary line will be getting installed today.
Miscellaneous Correction
Informational
07/14/2021
5-28-21: No work going on due to the rain on 5-27-21
Misc
Informational
07/14/2021
6/2/21- MH 4-A2 has been placed, Roughly 200 ft of 8” pvc SDR-26 has been layed. Base and cover rock was tamped in.
Misc
Informational
07/14/2021
Crew has installed pipe up to MH 4-A3, MH 4-A3 has been placed. Crew has also installed service lines for lots 90-88. The crew is still installing pipe and Y’s.
Misc
Informational
07/14/2021
6/4/21- Crew installed trench checks for lots 95,90, 89, 88, 96, 97, 98, and 99. Cleaning up and securing the site before the weekend.
Misc
Informational
07/14/2021
6/7/21- Crew is working installing the service lines. MH 4-A4 has been placed and crew is working off it heading up to MH 4-5A
Misc
Informational
07/14/2021
6/8/21- Crew placed MH 4-A5, laid services lines 87 earlier in the week and 86, and 85 today. Still waiting for the trench check on these lines. Now working out of MH 4-A5 headed East up to SW Enoch St.
Misc
Informational
07/14/2021
6/9/21- Crew is installing 8” PVC SDR-26 roughly 150 ft was placed today, they laid the service line for lot 111 waiting on the trench checks. Crew is in heavy rock.
Misc
Partial Correction
07/14/2021
6/10/21- Crew has MH 4-A6 and MH 4-A7 placed, plan on working up Enoch St. Trench checks will be poured today @ 5PM Crew is working out of MH 4-A7 up to MH 4-A8 Building up MH 4-A4 to grade.
Misc
Informational
07/14/2021
Trench checks was poured on Friday morning, crew left for the day after 1PM 6/14/21 9:30AM- Two crews are working on site, One crew is installing services line but are in heavy rock. Second crew is almost to MH 4-A9 and then will be heading back to install service lines. 14:20- Crew has MH 4-A9 placed, installed service lines for lots 105, 106, 107, 108, and 109.
Misc
Informational
07/14/2021
6/15/21 10:00- Two crews working. One crew is installing trench checks for the services lines off SW Enroch St, also still digging out a few of the service lines. Second crew is working laying line 4-15 out of MH 4-A5 headed West to MH 4-D1. 6/16/21 11:00- Two crews still working, first crew is setting up MH 4-A2. Second crew has set MH 4-D1 and is installing pipe put to MH 4-D2.
Misc
Informational
07/14/2021
6//17/21 9:00- Two crews working again today. One crew is working on installing sewer lines from MH 4-D2 to MH 4-D3 on SW Saddlebred Ter. Second crew is working on back filling the service lines for lots 93,94,95, 92, and 91. Now starting out installing sewer from MH 4-A2 headed to MH 4-C1. All service lines are installed on SW Enroch St, services lines have also had trench checks installed. 14:30- First crew is about to install MH 4-D3. Second crew is still back filling service lines for the lots 93,94,95,92 and 91.
Misc
Informational
07/14/2021
6/21/21 8:30 - Second crew left, main crew is working on installing service lines on SW Saddlebred Ter for lots 113, 114, 115, and. 116. 13:10- Crew is still working on the service lines, they are into the heavy rock.
Misc
Informational
07/14/2021
6/22/21 9:00- Crew is still working on the service lines on Saddlebred Ter, flowfill should be in for the trench checks around 12:30 today. 14:30- Trench checks placed, crew is currently back filling. 6/23/21 9:50- Service lines have been back filled for Saddlebred Ter, crew has placed MH 4-C1 and is currently working towards MH 4-C2. 14:00- Crew is placing MH 4-C2 and will be starting to work out of it to MH 4-C3. Due to the sanitary being at 1% fall crew is tamping rock before the pipe and also tamping the rock cover after the pipe. Foreman also informed me that they are waiting on cones for the MH’s.
Misc
Informational
07/14/2021
6/24/21- Foreman sent me a text to let me know that they aren’t working today due to the rain. 6/28/21 8:50- Crew is currently placing cones on the MH’s. Crew left for the day due to rain. 6/29/21 6:30- Crew sent me a text letting me know that they aren’t working today due to the rain. 6/30/21 7:30- Crew texted me letting me know no work due to weather. 7/1/21 7:00- No work for the rest of the week due to weather. 7/7/21 14:00- Crew installed pipe between MH 4C-2 to MH 4C-3. If weather allows they will be installing the service lines.
Misc
Informational
07/14/2021
7/8/21 9:00- Crew is installing service lines for lots 77, 76. 13:35 Crew has dug out the service lines for lots 75, 81, 80 and is currently working on laying pipe out of MH 4-C3 MH 4-C4. Trench checks will be poured tomorrow morning around 7AM.
Misc
Informational
07/14/2021
7/9/21 9:00- Crew placed trench checks for the lots on Serena Pl, now back filling and getting ready for the rain this weekend.
Misc
Informational
07/14/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/14/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/14/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/14/2021
7/12/21 9:30- Crew is installing pipe and has hit shelf rock, close to MH 4-C4. 14:15- Crew has set MH 4-C4 and the service line for lot 84, 83, and 82. Trench checks for these will be poured tomorrow morning.
Misc
Informational
07/14/2021
7/13/21 14:00- Crew is moving storm boxes into place on the KCMO side. MH-C4 cone was hit during the back fill process and will need to be replaced. 7/14/21 14:00- Spoke to the foreman about putting everything on the 30 day wait time to start the testing other than MH-C4 that one will be put on the 30 day wait period when the new cone comes in and replaces the cracked one and they get everything sealed back up.
Misc
Informational
07/14/2021
7/13/21 14:00- Crew is moving storm boxes into place on the KCMO side. MH-C4 cone was hit during the back fill process and will need to be replaced. 7/14/21 14:00- Spoke to the foreman about putting everything on the 30 day wait time to start the testing other than MH-C4 that one will be put on the 30 day wait period when the new cone comes in and replaces the cracked one and they get everything sealed back up.
Misc
Informational
08/13/2021
8/12/21 8:40 - Crew has placed a camera in the sanitary sewer line, found a sag and fixed that one, but currently looking for more. 14:00 - Crew found more sags further down the line and spent the day fixing them and back filling.
Misc
Informational
10/18/2021
On 10/13/2021 Lee’s Summit Water Utilities completed their inspection of Summit View Farms 4th Plat and found a dirt clod in MH 55-136 that needs to be removed.
Sanitary - Material Verification Passed 01/19/2022
Erosion Control Inspection Failed 02/08/2022
Misc
Informational
02/08/2022
Erosion control failed
Water Line - Construction Inspection Passed 8/19/2021 8/19/2021 02/08/2022
Misc
Informational
08/17/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
08/17/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Misc
Informational
08/19/2021
8/18/21 - Roughly 400 ft of 8in water line was installed down Summit View Trail. 8/19/21 - Roughly 200 ft of 8in water line was installed down Summit View Trail, rest of the day was spent back filling.
Storm Sewer Construction Inspection Passed 9/1/2021 9/1/2021 02/16/2022
Misc
Informational
08/10/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
08/10/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
08/10/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
08/10/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Misc
Informational
08/10/2021
8/2/21 9:40 - Digging out for JB 4-13B, and CI 4-10C. Should have those boxes later today. 8/3/21 7:30 - Yesterday evening the crew installed 56.88 LF of 30” HDPE between FI 4-10F and FI 4-10G. This morning they placed CI 4-10C and put in 109.08 LF of 42” HDPE between CI 4-10C to CI 4-10D.
Misc
Informational
08/10/2021
8/4/21 10:30- Yesterday to this morning the crew installed 42.47LF of 24” HDPE from JB 4-13B to MH 4-HDS1. Also installed 15.94LF of 24” HDPE from MH 4-HDS1 to CI 4-13C. Also installed CI 4-14A and 42.50LF of 15” RCP between CI 4-14A to CI 4-13C. 14:00 - Crew has installed 131.86LF of 18” HDPE from CI 4-13C to CI 4-13D, installed CI 4-13D and then installed 34.25LF of 18” HDPE to CI 4-13E and then installed CI 4-13E.
Misc
Informational
08/10/2021
Last Thursday and Friday crew installed 195.1 LF of 15” HDPE and also installed CI 4-13E, CI 4-13F, and CI 4-13G. Crew also installed on last week and Monday STM line 4-15 and STM line 4-15. They informed me that all the storm infrastructure is in but two boxes. Crew also poured inverts on Friday and Monday.
Misc
Informational
09/01/2021
9/1/21 9:45 - Crew installed FI 4-10F and roughly 40ft of 30” HDPE. Still waiting of some storm lids for a few boxes.
Water Line - Construction Inspection Passed 9/1/2021 9/1/2021 02/16/2022
Misc
Informational
08/27/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
08/27/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Misc
Informational
08/27/2021
8/18/21 - Roughly 400 ft of 8in water line was installed down Summit View Trail. 8/19/21 - Roughly 200 ft of 8in water line was installed down Summit View Trail, rest of the day was spent back filling.
Misc
Informational
08/27/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/27/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/27/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/27/2021
8/26/21 15:00 - Crew laid roughly 250 ft of 8in pvc up Saddlebred Terr, started laying 6in pvc on Serena Pl, and installed thrust blocks on the 22.5 and 45’s.
Misc
Informational
08/27/2021
8/27/21 9:40 - Crew is cleaning up the site for the weekend, back filling, setting up esc around boxes. Asked to place orange fencing around open holes. Yesterday they got half the 6in pvc installed.
Misc
Informational
08/31/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
08/31/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
08/31/2021
8/31/21 10:00 - Crew planned to pour kickers for the 6in line, rain was close. Crew was working on installing storm and prepped area before rain.
Misc
Informational
09/01/2021
9/1/21 9:40 - Crew poured kickers yesterday after the rain passed. Waiting to start the water line testing.
Water Line - Construction Inspection Passed 8/27/2021 8/27/2021 02/16/2022
Misc
Informational
08/26/2021
8/11/21 9:30 - The crew has started installing the water line. 15:00 - Crew laid roughly 800 ft of 8” PVC water line down Kline and down Enoch.
Misc
Informational
08/26/2021
8/17/21 - Roughly 650 ft of 8” water line was placed.
Misc
Informational
08/26/2021
8/18/21 - Roughly 400 ft of 8in water line was installed down Summit View Trail. 8/19/21 - Roughly 200 ft of 8in water line was installed down Summit View Trail, rest of the day was spent back filling.
Misc
Informational
08/26/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/26/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/26/2021
8/23/21 9:00 - Crew is installing fire hydrants STA 6+03.68, STA 5+61.66. Afternoon they started digging. 8/24/21 14:30 - Crew installed 60ft and tied in on water line 4-01, a field change will take place they had to add in an extra 22 degree fitting. When I left they was working on water line 4-03. 8/25/21 13:30 - Crew installed roughly 500 ft of 8” pvc up Saddlebred terr.
Misc
Informational
08/26/2021
8/26/21 15:00 - Crew laid roughly 250 ft of 8in pvc up Saddlebred Terr, started laying 6in pvc on Serena Pl, and installed thrust blocks on the 22.5 and 45’s.
Misc
Informational
08/27/2021
8/27/21 9:40 - Crew is cleaning up the site for the weekend, back filling, setting up esc around boxes. Asked to place orange fencing around open holes. Yesterday they got half the 6in pvc installed.
Water Line - Hydrostatic Test Passed 02/17/2022
Water Line - Hydrostatic Test Passed 02/17/2022
Sanitary Sewer - Camera Test Passed 2/18/2022 02/17/2022
Master Drainage As-built Inspection Passed 1/18/2022 02/17/2022
Grading/Excavation/Fill Inspection Passed 02/17/2022
Misc
Informational
09/23/2021
On Thursday 9/23/2021 I observed mass grading in various locations throughout project site. On Thursday 9/30/2021 Contractor, Ray Spalding conducted mass grading throughout the site.
Storm Sewer Construction Inspection Passed 02/17/2022
Misc
Informational
09/01/2021
Crew is installing storm sewer and has hit rock, they have been breaking up the rock and have installed MH 4-A1. Now starting to lay pipe out of MH 4-A1 but have hit more rock.
Misc
Informational
09/01/2021
7/26/21 15:00 - Crew has installed 128.27 LF of 15”HDPE that was coming out of CI-10I headed up to Monarch Dr. Crew also placed JB 4-10A 7/27/21 15:15 - Crew has placed 183.98 LF of 42” HDPE, placed ci 4-10B, CI 4-10C and STM Line 4-12.
Misc
Informational
09/01/2021
7/28/21 10:15 - Yesterday evening ( 7/27/21 ) crew installed 97.65 LF of 42” HDPE from CI 4-10D to CI 4-10E. This morning they poured collars on what was installed this morning. Currently installing STM Line 4-11 working out of JB 4-10A. 13:30 - Crew pulled off to fix some sanitary line that had sags in it. 7/29/21 13:30 - Crew laid 139.24 LF of 30” HDPE from CI 4-10E to FI 4-10F. They also laid 88.77 LF of 36” HDPE out of CI 4-10E to CI 4-13A and also sat CI 4-13A.
Misc
Informational
09/01/2021
7/30/21 9:00 - Yesterday evening the crew laid 210.79 LF of 36” RCP out of CI 4-13A to JB 4-13B ( currently waiting for this box before install ). They also poured inverts and collars on a few boxes. Installing lids and risers on boxes 4-10 a,b,and c. Silt fence is being installed around inlets as well.
Misc
Informational
09/01/2021
8/2/21 9:40 - Digging out for JB 4-13B, and CI 4-10C. Should have those boxes later today. 8/3/21 7:30 - Yesterday evening the crew installed 56.88 LF of 30” HDPE between FI 4-10F and FI 4-10G. This morning they placed CI 4-10C and put in 109.08 LF of 42” HDPE between CI 4-10C to CI 4-10D.
Misc
Informational
09/01/2021
8/4/21 10:30- Yesterday to this morning the crew installed 42.47LF of 24” HDPE from JB 4-13B to MH 4-HDS1. Also installed 15.94LF of 24” HDPE from MH 4-HDS1 to CI 4-13C. Also installed CI 4-14A and 42.50LF of 15” RCP between CI 4-14A to CI 4-13C. 14:00 - Crew has installed 131.86LF of 18” HDPE from CI 4-13C to CI 4-13D, installed CI 4-13D and then installed 34.25LF of 18” HDPE to CI 4-13E and then installed CI 4-13E.
Misc
Informational
09/01/2021
Last Thursday and Friday crew installed 195.1 LF of 15” HDPE and also installed CI 4-13E, CI 4-13F, and CI 4-13G. Crew also installed on last week and Monday STM line 4-15 and STM line 4-15. They informed me that all the storm infrastructure is in but two boxes. Crew also poured inverts on Friday and Monday.
Misc
Informational
09/01/2021
9/1/21 9:45 - Crew installed FI 4-10F and roughly 40ft of 30” HDPE. Still waiting of some storm lids for a few boxes.
Pavement-Stabilized Subgrade Passed 02/17/2022
Misc
Informational
10/18/2021
On 10/6/2021 I observed the application of the chemical stabilization on the roads in Summit View Farms
Install Street and Stop Signs Passed 02/17/2022
Pavement-Aggregate Base Passed 02/17/2022
Pavement-Curb Construction Passed 02/17/2022
Pavement-Stabilized Subgrade Passed 02/17/2022
Misc
Informational
10/06/2021
10/6/2021 contractor Spalding conducted chemical stabilization of pavement for streets.
Record Drawing Review Passed 1/14/2022 04/13/2022
Erosion Control Inspection Failed 04/29/2022
Misc
Informational
02/08/2022
Erosion control failed 4.29.2022 Erosion Failed. Muddy roads. No erosion control fencing is in place. See photos dated 4.29.2022
Record Drawing Review Passed 5/23/2022 06/01/2022
Misc
Informational
06/01/2022
On 5/23/2022 I have completed my review and the water drawings appear to be constructed as designed. The sanitary and storm drawings don’t have any major elevation changes.
Site Visit Partial 8/9/2022 08/09/2022
Misc
Informational
08/09/2022
Water dept. noticed that Summit View trl. did not have water in the line when they did a tap. Redford retested the line and we have put one passing sample into documents and images. I have sent the sample over to water dept. and we will go out and make sure all the valves are on ageain tomorrow morning.Steve Robbins 08/09/2022 3:21 PM
Erosion Control Inspection Failed 08/24/2022
Misc
Informational
04/29/2022
Erosion control failed 4.29.2022 Erosion Failed. Muddy roads. No erosion control fencing is in place. See photos dated 4.29.2022
Misc
Corrective Action Required
08/24/2022
8-24-22 RH. Erosion control failed. Inlets are filled with silt and vegetation is growing out of it. Silt fence is down in multiple places causing silt to run onto road. Inlets need to be cleaned out and silt fence repaired throughout entire subdivision.
Erosion Control Inspection Passed 08/26/2022
Misc
Informational
08/24/2022
Erosion control failed 4.29.2022 Erosion Failed. Muddy roads. No erosion control fencing is in place. See photos dated 4.29.2022
Misc
Corrective Action Required
08/24/2022
8-24-22 RH. Erosion control failed. Inlets are filled with silt and vegetation is growing out of it. Silt fence is down in multiple places causing silt to run onto road. Inlets need to be cleaned out and silt fence repaired throughout entire subdivision. 8-26-22 RH. Inlets were all cleaned out and silt and vegetation was removed.
Install Street and Stop Signs Passed 09/01/2022
Pavement-Aggregate Base Passed 09/01/2022
Storm Sewer Construction Inspection Passed 7/23/2021 7/23/2021 09/01/2022
Misc
Informational
07/23/2021
7/22/21 14:27 - Crew started at the FI4-10G placed that box then installed 138.67 LF of 24” HDPE to CI 4-10H, they sat CI 4-10H. They laid 34.22 LF of 24” HDPE to box CI 4-10I, CI 4-10I has been sat. Crew also installed 40LF of 15” HDPE out of the box CI 4-10I. 7/23/21 10:10 - Crew is working on the Kansas City side and cleaning up the site before the weekend.
Pavement-Curb Construction Passed 09/01/2022
Misc
Informational
10/20/2021
10/20/2021 I observed contractor, JK Concrete Construction setting out string lines for curb placement. 11/3/2021 Spalding Excavating performed a curb proof roll using a 20.40 ton tandem truck. Curb installation is set for next day’s business. Proof roll passed for curb placement.. 11/8/2021 Contractor, JK Concrete completed curb placement and have progressed to pouring curb inlet throats and contractor, Randy Spalding is backfilling the curbing throughout the project site.
Documents & Images
Date Uploaded File Type Document Name
03/10/2021 Receipt Receipt for transaction:2021-001182
03/11/2021 Approved Plans Summit View Farms, 4th plat - ESC, Mass Grade, Paving and Storm Approved 3.11.21
03/11/2021 Approved Plans Summit View Farms, 4th plat - Water Approved 3.11.21
03/12/2021 Approved Plans Summit View Farms, 4th plat - Sanitary Approved 3.11.21
05/25/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/26/2021 Letter INSPECTION SUMMARY
05/28/2021 Letter INSPECTION SUMMARY
05/28/2021 Letter INSPECTION SUMMARY
06/01/2021 Letter INSPECTION SUMMARY
06/01/2021 Letter INSPECTION SUMMARY
06/02/2021 Letter INSPECTION SUMMARY
06/02/2021 Letter INSPECTION SUMMARY
06/03/2021 Letter INSPECTION SUMMARY
06/04/2021 Letter INSPECTION SUMMARY
06/07/2021 Letter INSPECTION SUMMARY
06/08/2021 Letter INSPECTION SUMMARY
06/09/2021 Letter INSPECTION SUMMARY
06/10/2021 Letter INSPECTION SUMMARY
06/14/2021 Letter INSPECTION SUMMARY
06/16/2021 Letter INSPECTION SUMMARY
06/17/2021 Letter INSPECTION SUMMARY
06/21/2021 Letter INSPECTION SUMMARY
06/23/2021 Letter INSPECTION SUMMARY
07/07/2021 Letter INSPECTION SUMMARY
07/08/2021 Letter INSPECTION SUMMARY
07/14/2021 Letter INSPECTION SUMMARY
07/23/2021 Letter INSPECTION SUMMARY
07/27/2021 Letter INSPECTION SUMMARY
07/29/2021 Letter INSPECTION SUMMARY
07/30/2021 Letter INSPECTION SUMMARY
08/03/2021 Letter INSPECTION SUMMARY
08/04/2021 Letter INSPECTION SUMMARY
08/10/2021 Letter INSPECTION SUMMARY
08/11/2021 Letter INSPECTION SUMMARY
08/13/2021 Letter INSPECTION SUMMARY
08/16/2021 Letter INSPECTION SUMMARY
08/17/2021 Letter INSPECTION SUMMARY
08/19/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/26/2021 Letter INSPECTION SUMMARY
08/27/2021 Letter INSPECTION SUMMARY
09/01/2021 Letter INSPECTION SUMMARY
09/01/2021 Letter INSPECTION SUMMARY
09/02/2021 Letter INSPECTION SUMMARY
09/07/2021 Letter INSPECTION SUMMARY
09/09/2021 Letter INSPECTION SUMMARY
09/16/2021 Water test #1 passed.pdf
09/16/2021 Letter INSPECTION SUMMARY
09/16/2021 Water test #2 Passed.pdf
09/16/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
09/23/2021 Letter INSPECTION SUMMARY
10/18/2021 Letter INSPECTION SUMMARY
10/19/2021 Letter INSPECTION SUMMARY
11/11/2021 Letter INSPECTION SUMMARY
11/12/2021 Letter INSPECTION SUMMARY
11/15/2021 Letter INSPECTION SUMMARY
01/06/2022 Water Line Plan Set_SVF4_As-Built_01-06-2022
01/12/2022 As-Graded MDP_Revision 0_01-12-2022
01/12/2022 As-Graded Swale_Revision 0_01-12-2022
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
01/31/2022 Letter INSPECTION SUMMARY
02/08/2022 Letter INSPECTION SUMMARY
02/10/2022 Test Results for Water Sample #1 - WU Bond Inspection
02/10/2022 Test Results for Water Sample #2 - WU Bond Inspection
02/14/2022 Summit View Farms 4th Plat Water Samples
02/14/2022 Summit View Farms 4th 2nd Passing Water Samples
02/16/2022 Letter DE-Certificate of Substantial Completion Multiple Lot
02/17/2022 Letter DE-Punch List
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/23/2022 Letter INSPECTION SUMMARY
02/25/2022 Summit View Farms 4th Plat Substantial Completion
02/25/2022 Summit View Farms 4th Plat Punch List
02/25/2022 Summit View Farms 4th Plat Maintenance Bond
02/14/2022 Test Results for Water Sample #3. Serena Place - WU Bond Inspection
04/28/2022 Letter INSPECTION SUMMARY
04/29/2022 4_29_2022 Erosion control measures failed
04/29/2022 4_29_2022 Erosion Control Measures_2
04/29/2022 Letter INSPECTION SUMMARY
05/13/2022 MG ESC PAV STM Set_SVF4_As-Build_05-13-2022
05/13/2022 Water Line Plan Set_SVF4_As-Built_05-13-2022
06/01/2022 Letter INSPECTION SUMMARY
08/09/2022 Summit View Farms 4th Plat Water Samples
08/09/2022 Summit View Farms 4th Plat Water Samples
08/09/2022 Summit view farms 4th Plat Water Sample -August
08/09/2022 Letter INSPECTION SUMMARY
08/10/2022 Water Test#1 flushing line.8.3.2022
08/10/2022 Water Test#2 flushing line.8.4.2022
08/24/2022 Letter INSPECTION SUMMARY
08/26/2022 Letter INSPECTION SUMMARY
07/31/2023 Letter DE-Certificate of Final Acceptance (Commercial)
11/19/2024 Letter PW ROW Inspections Report
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
