Summary


PRSUBD20193625
Public Infrastructure
Final Acceptance
CITY OF LEES SUMMIT
DEVELOPMENT COMPLETE
Streets of West Pryor - Pryor Road Signal improvements/Lane Widening
12/16/2019
12/30/2019
02/29/2024
Locations
Contacts
CITY OF LEES SUMMIT, Address:220 SE GREEN ST
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 12/16/2019 12/18/2019
Joe Starlin
Fees
Paid Fees Amount Paid Owing Date Paid
9110068-Storm Fee $268.20 $268.20 Paid Not payable online 12/16/2019
9110081-Paved Surface Inspection Fee $20,059.25 $20,059.25 Paid Not payable online 12/16/2019
9110071-Site Grading Fee $180.00 $180.00 Paid Not payable online 12/16/2019
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $50.00 $0.00 $50.00 Not Paid


$50.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Miscellaneous PWORKS Inspection Partial 3/30/2020 03/30/2020
Misc
Informational
03/30/2020

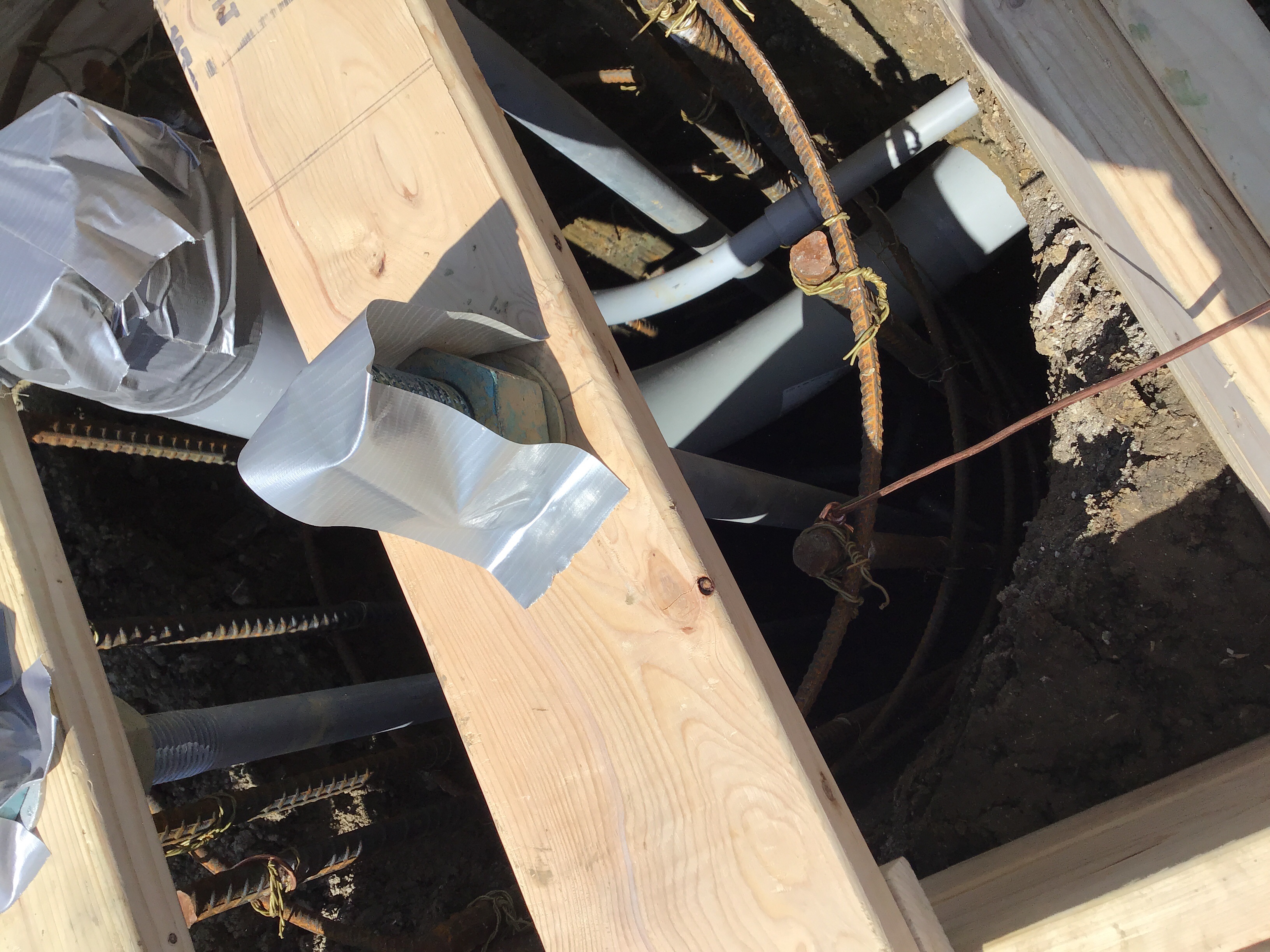

3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Miscellaneous PWORKS Inspection Partial 4/1/2020 04/01/2020
Misc
Informational
03/30/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/01/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Miscellaneous PWORKS Inspection Partial 4/3/2020 04/03/2020
Misc
Informational
04/01/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/01/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/02/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/03/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Miscellaneous PWORKS Inspection Partial 4/8/2020 04/08/2020
Misc
Informational
04/03/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/03/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/03/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/03/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/08/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Miscellaneous PWORKS Inspection Partial 4/9/2020 04/09/2020
Misc
Informational
04/08/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/08/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/08/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/08/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/08/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/09/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Miscellaneous PWORKS Inspection Partial 04/10/2020
Misc
Informational
04/09/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/09/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/09/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/09/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/09/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/09/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/10/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Miscellaneous PWORKS Inspection Partial 4/13/2020 04/13/2020
Misc
Informational
04/10/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/10/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/10/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/10/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/10/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/10/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/10/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/13/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Miscellaneous PWORKS Inspection Partial 4/14/2020 04/14/2020
Misc
Informational
04/13/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/13/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/13/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/13/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/13/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/13/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/13/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/13/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/14/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Miscellaneous PWORKS Inspection Partial 4/14/2020 04/15/2020
Misc
Informational
04/14/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/14/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/14/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/14/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/14/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/14/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/14/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/14/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/14/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
04/15/2020

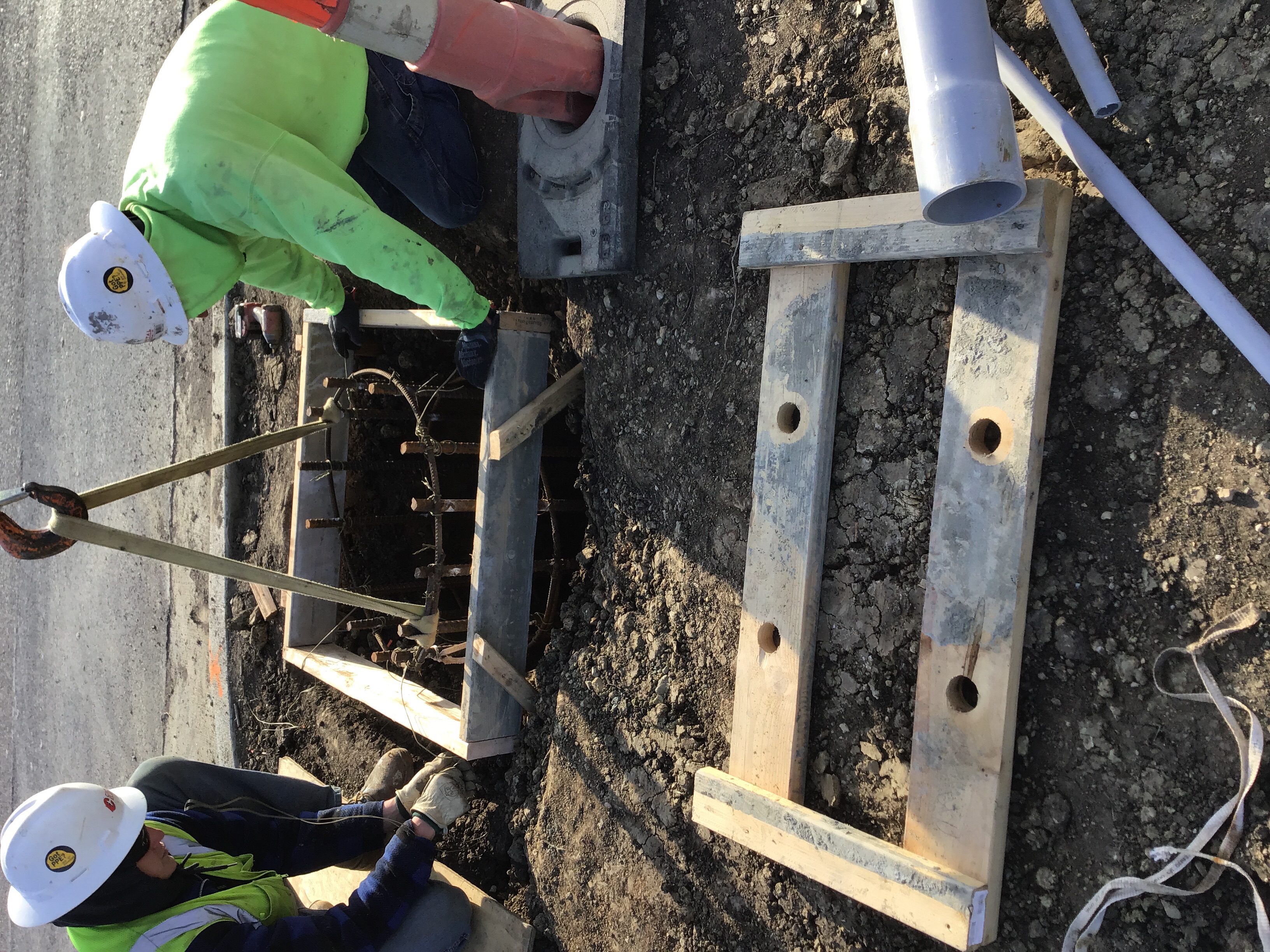

4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Miscellaneous PWORKS Inspection Partial 4/15/2020 04/16/2020
Misc
Informational
04/15/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/15/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/15/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/15/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/15/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/15/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/15/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/15/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/15/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
04/15/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
04/15/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons.
Miscellaneous PWORKS Inspection Partial 4/21/2020 04/21/2020
Misc
Informational
04/16/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/16/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/16/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/16/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/16/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/16/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/16/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/16/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/16/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
04/16/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
04/16/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes.
Miscellaneous PWORKS Inspection Partial 04/29/2020
Misc
Informational
04/21/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/21/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
04/21/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/21/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/21/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/21/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/21/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/21/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/21/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
04/21/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
04/21/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Miscellaneous PWORKS Inspection Partial 5/1/2020 05/01/2020
Misc
Informational
04/29/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
04/29/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
04/29/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
04/29/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
04/29/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
04/29/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
04/29/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
04/29/2020

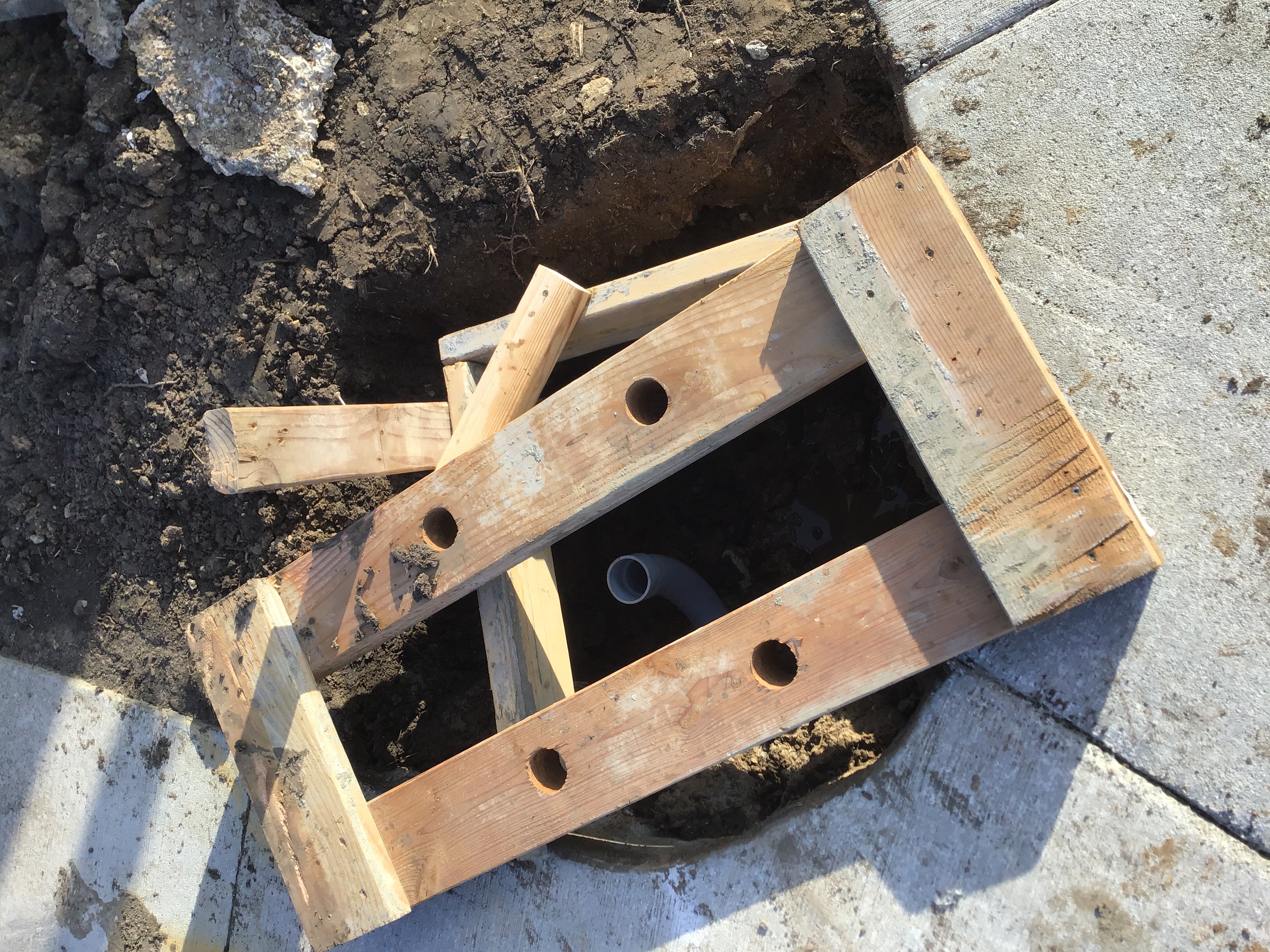

4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
04/29/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
04/29/2020

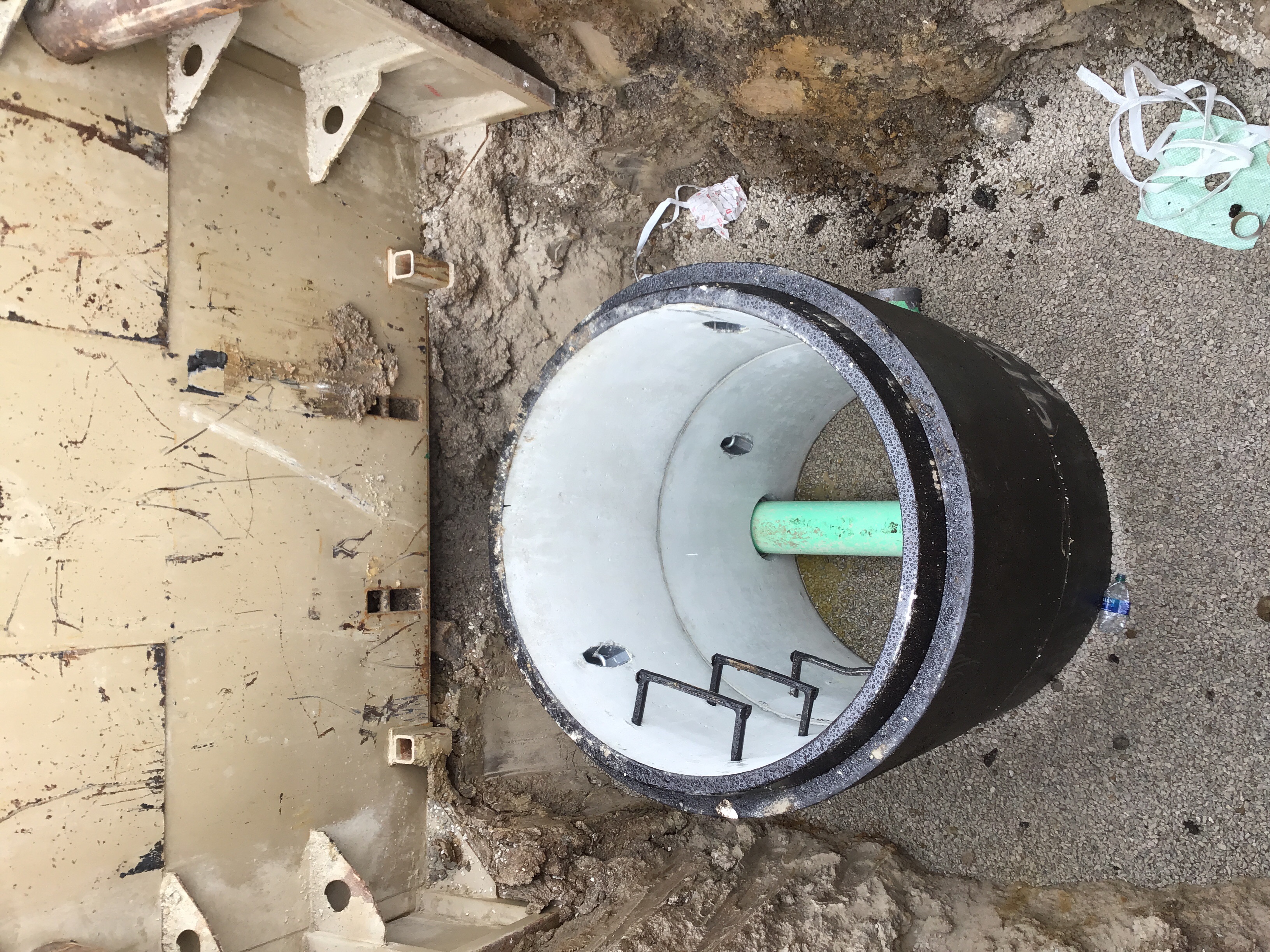

4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
04/29/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/01/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein.
Miscellaneous PWORKS Inspection Partial 5/6/2020 05/06/2020
Misc
Informational
05/01/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/01/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/01/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/01/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/01/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/01/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/01/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/01/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/01/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/01/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/01/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/01/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit.
Miscellaneous PWORKS Inspection Partial 5/11/2020 05/11/2020
Misc
Informational
05/06/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/06/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/06/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/06/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/06/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/06/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/06/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/06/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/06/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/06/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/06/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/06/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Miscellaneous PWORKS Inspection Partial 5/12/2020 05/12/2020
Misc
Informational
05/11/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/11/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/11/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/11/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/11/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/11/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/11/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/11/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/11/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/11/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/11/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/11/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
05/11/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein.
Pavement-Proof Roll Partial 05/13/2020
Misc
Informational

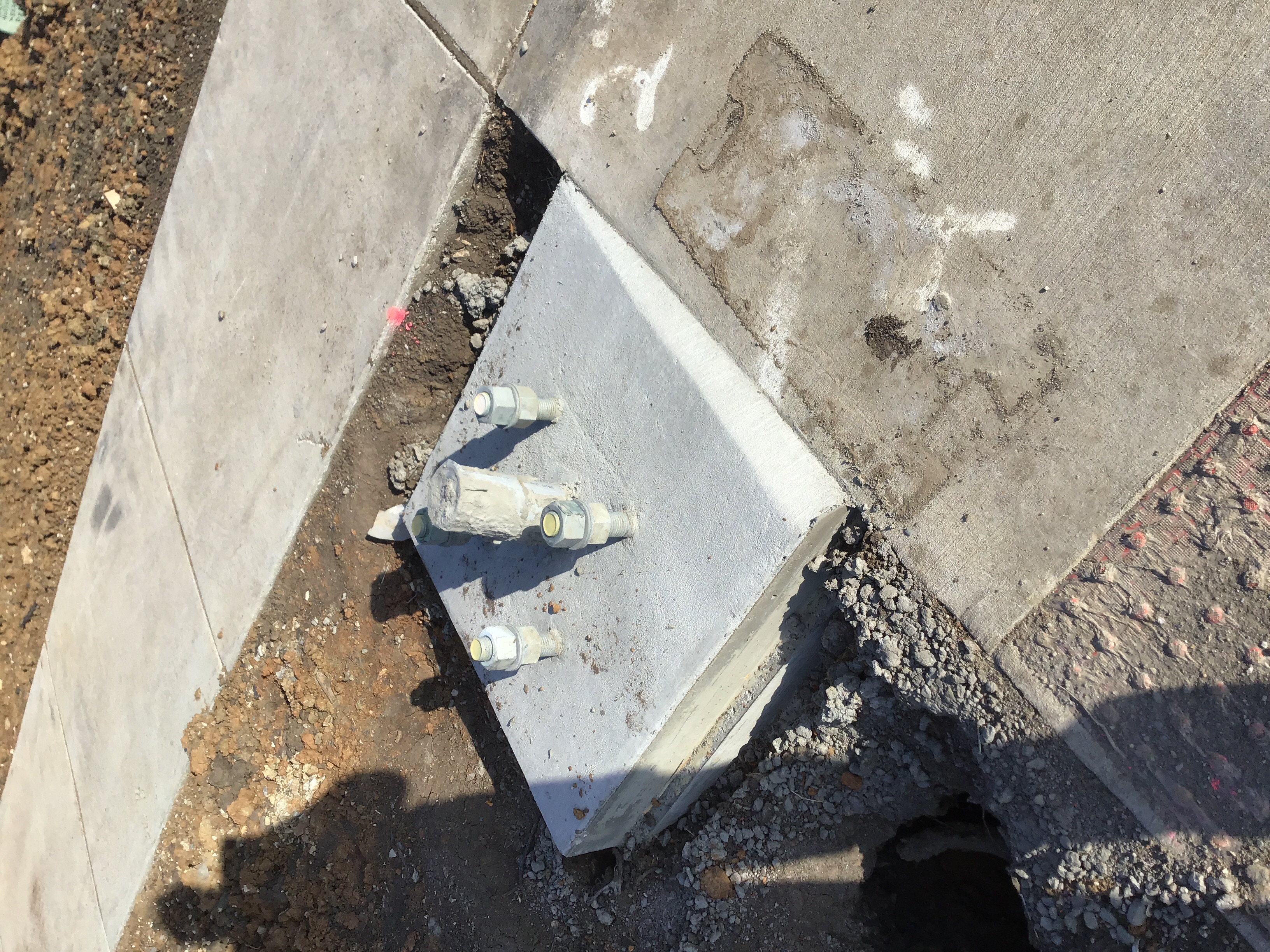

05/13/2020
5-13-20 8:59am ESS proof rolled Two turn lanes on Pryor rd. They have both passed. Rain is moving in and the lanes will require a second proof roll with any rain fall.
Miscellaneous PWORKS Inspection Partial 05/18/2020
Misc
Informational
05/12/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/12/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/12/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/12/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/12/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/12/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/12/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/12/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/12/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/12/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/12/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/12/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
05/12/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470.
Miscellaneous PWORKS Inspection Partial 5/27/2020 5/27/2020 05/27/2020
Misc
Informational
05/18/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/18/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/18/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/18/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/18/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/18/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/18/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/18/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/18/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/18/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/18/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/18/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
05/18/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470. 5-27-20 Capital will have the signal turn on for Pryor rd. And Lowenstein on June 4th at 9am. They will have Mid Am Signal, ETI, and Rythem on site for the cameras. It is possible they will have 4 pedestal poles not in operation yet. Sidewalks will play a factor. The signal will have a 2 week flash time.
Miscellaneous PWORKS Inspection Partial 6/4/2020 6/4/2020 06/04/2020
Misc
Informational
05/27/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
05/27/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
05/27/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
05/27/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
05/27/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
05/27/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
05/27/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
05/27/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
05/27/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
05/27/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
05/27/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
05/27/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
05/27/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470. 5-27-20 Capital will have the signal turn on for Pryor rd. And Lowenstein on June 4th at 9am. They will have Mid Am Signal, ETI, and Rythem on site for the cameras. It is possible they will have 4 pedestal poles not in operation yet. Sidewalks will play a factor. The signal will have a 2 week flash time. 6-4-20 9:25am Capital is on site with Scott Koch. They are testing the signals and will put them in flash mode for 14 days.
Pavement-Proof Roll Partial 6/8/2020 6/8/2020 06/08/2020
Misc
Informational
05/13/2020
5-13-20 8:59am ESS proof rolled Two turn lanes on Pryor rd. They have both passed. Rain is moving in and the lanes will require a second proof roll with any rain fall. 6-8-20 We have proof rolled both turn lanes on Pryor and the drive at Pryor and Summit Wood. Private road C has passed as well.
Pavement-Surface Partial 6/9/2020 6/9/2020 06/09/2020
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C.
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C. They have started laying asphalt on the turn lane for Summit Woods.
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C. They have started laying asphalt on the turn lane for Summit Woods. Metro Asphalt has the base on all three turn lanes on Pryor and are working on Private Rd C. CFS is on site for all testing.
Sidewalk Inspection Partial 6/11/2020 6/11/2020 06/11/2020
Misc
Informational
06/11/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor.
Sidewalk Inspection Partial 06/19/2020
Misc
Informational
06/11/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor. 6-19-20 On 6-17-20 ESS poured the sidewalks on the east side of Lowenstein and Pryor.
Street - Surface Course Partial 6/28/2020 6/28/2020 06/28/2020
Misc
Informational
06/28/2020
Misc
Informational
06/28/2020
6-28-20 5:36pm Metro is laying asphalt in the turning lanes on Pryor. They are using Type 5. 7:40pm They are done laying the surface asphalt.
Street - Surface Course Partial 6/30/2020 6/30/2020 06/30/2020
Misc
Informational
06/28/2020
Misc
Informational
06/28/2020
6-28-20 5:36pm Metro is laying asphalt in the turning lanes on Pryor. They are using Type 5. 7:40pm They are done laying the surface asphalt. 6-30-20 2:14pm K&G Striping have started laying out Pryor Rd. Stripes.
Sidewalk Inspection Partial 6/30/2020 6/30/2020 06/30/2020
Misc
Informational
06/19/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor. 6-19-20 On 6-17-20 ESS poured the sidewalks on the east side of Lowenstein and Pryor. 6-30-20 7:28am ESS have poured sidewalk from Lowenstein heading north to private rd C. They are now setting up for the ADA at road C. 2:19pm ESS is pouring the sidewalk at the Southwest corner of Private Rd C. They are getting there concrete from PCI.
Street - Surface Course Partial 07/01/2020
Misc
Informational
06/30/2020
Misc
Informational
06/30/2020
6-28-20 5:36pm Metro is laying asphalt in the turning lanes on Pryor. They are using Type 5. 7:40pm They are done laying the surface asphalt. 6-30-20 2:14pm K&G Striping have started laying out Pryor Rd. Stripes. 7-1-20 1:35pm Metro Asphalt is filling in the seem at the Private Rd drive and Pryor.
Sidewalk Inspection Partial 7/2/2020 7/2/2020 07/02/2020
Misc
Informational
06/30/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor. 6-19-20 On 6-17-20 ESS poured the sidewalks on the east side of Lowenstein and Pryor. 6-30-20 7:28am ESS have poured sidewalk from Lowenstein heading north to private rd C. They are now setting up for the ADA at road C. 2:19pm ESS is pouring the sidewalk at the Southwest corner of Private Rd C. They are getting there concrete from PCI. 7-2-20 ESS are going to try to pour two ADA ramps today.
Miscellaneous PWORKS Inspection Partial 07/07/2020
Misc
Informational
06/04/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
06/04/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
06/04/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
06/04/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
06/04/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
06/04/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
06/04/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
06/04/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
06/04/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
06/04/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
06/04/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
06/04/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
06/04/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470. 5-27-20 Capital will have the signal turn on for Pryor rd. And Lowenstein on June 4th at 9am. They will have Mid Am Signal, ETI, and Rythem on site for the cameras. It is possible they will have 4 pedestal poles not in operation yet. Sidewalks will play a factor. The signal will have a 2 week flash time. 6-4-20 9:25am Capital is on site with Scott Koch. They are testing the signals and will put them in flash mode for 14 days. 7-7-20 Capital have set pedestals at Lowenstein and are close to finishing.
Miscellaneous PWORKS Inspection Partial 07/08/2020
Misc
Informational
07/07/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
07/07/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
07/07/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
07/07/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
07/07/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
07/07/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
07/07/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
07/07/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
07/07/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
07/07/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
07/07/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
07/07/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
07/07/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470. 5-27-20 Capital will have the signal turn on for Pryor rd. And Lowenstein on June 4th at 9am. They will have Mid Am Signal, ETI, and Rythem on site for the cameras. It is possible they will have 4 pedestal poles not in operation yet. Sidewalks will play a factor. The signal will have a 2 week flash time. 6-4-20 9:25am Capital is on site with Scott Koch. They are testing the signals and will put them in flash mode for 14 days. 7-7-20 Capital have set pedestals at Lowenstein and are close to finishing. They installed at Lowenstein 1 8’ pedestal pole 4 15’ pedestal poles 6 pedestrian heads 6 push buttons 6 pedestrian signs Summit Woods 5 pedestrian heads 5 push buttons 5 pedestrian signs
Miscellaneous PWORKS Inspection Passed 7/9/2020 7/9/2020 07/09/2020
Misc
Informational
07/08/2020
3-30-20 11:17am Capital is on site. I spoke with Mike and he is laying everything out and wants to make a few changes to the plans. I told him I would speak to the PM about the changes.
Misc
Informational
07/08/2020
4-10-20 3:36pm Capital has has ran the power supply to the SW corner and have board the holes for two light poles at the NW corner of Lowenstein and the NW corner of Summit Wood. They have the steel installed and bolts and will be pouring them today.
Misc
Informational
07/08/2020
4-13-20 They have trenched in approximately 120’ of 3” conduit to transformer. They poured post 1 at Summit Woods Crossing and poured post 1 at Lowenstein.
Misc
Informational
07/08/2020
4-14-20 They excavated the southwest corner of Pryor an Summit to determine the location of the signal foundation between utilities. Drilled foundation on southwest corner of Pryor and Lowenstein. They mounted the signal controller cabinet at Lowenstein.
Misc
Informational
07/08/2020
4-14-20 They drilled and formed the foundation on SW corner at Summit Woods. They formed the foundation on SW corner of Lowenstein. The dug and formed the pedestal base on SW corner of Lowenstein.
Misc
Informational
07/08/2020
4-15-20 8:21am They are setting the steel at the SW corner. 4-16-20 All signal bases are done and 1 pedestal base. They have poured two aprons. 4-21-20 On 4-20 Capital trenched remaining conduit to South exiting fiber pull box. Approximately 60’. They set 2 fiber pull boxes. 4-27-20 Capital received all of the signal poles and arms for the job. 4-28-20 Capital pulled signal cables for the intersection at Summit Woods.
Misc
Informational
07/08/2020
4-9-20 Capital hit a blue irrigation line in several spots on the east side of Pryor. Brian called Kevin with Capital about this and they will make the repairs.
Misc
Informational
07/08/2020
4-8-20 3:32pm They drilled for the foundation on the SW corner and hit sanitary. They set pull box 1 and cleaned up dirt.
Misc
Informational
07/08/2020
4-3-20 On 4-2 Capital drilled , formed and poured post 5 at Summit Dr. They also dug and formed and poured the controller and power supply foundations at Lowenstein. Mike gave me the concrete tickets.
Misc
Informational
07/08/2020
4-2-20. On 3-31 All bores shot at Lowenstein. PB 1-4 4”, PB 4-3 4”, PB 3-2 4” PB 1- post 1 4” PB 4 Post 4 4”, PB 4 Post 5 2” PB 4 controller, PB 4- Power supply. Drilled foundation for post 2. 4-1-20. Lowenstein Drilled foundation for post 3. Formed and poured Post 2 and post 3.
Misc
Informational
07/08/2020
4-1-20 At 2:15pm They poured concrete for the two poles on the NE and SE corner of Pryor and Lowenstein. CFS is on site for the testing.
Misc
Informational
07/08/2020
4-20-20 Capital trenched remaining conduit to the South existing fiber pull box. Approximately 60’. They set two fiver pull boxes. 4-21-20 Capital tied in conduit dot signal foundation 4 at Lowenstein. They set pull box 2 at Summit Woods. They began excavation for pull box 1 and fiber pull box 9 at Summit Woods. 4-22-20 They set pull box 1 and 9 at Summit. They set fiber box 8. They tied in remaining fiber conduit. All fiber conduit is installled. All signal pull boxes are installed. All fiber pull boxes are installed. All signal conduit and foundations are installled with the exception of pedestal foundations.4-27-20 Capital received and unloaded signal poles and arms for the job. 4-28-20 Capital pulled in signal cables for the intersection at Summit Woods. 4-29-20 They pulled in signal cable for Lowenstein. 4-30-20 Capital retired post 3 an post 4 at Summit. They added head #11 to post 3. 5-1-20 Capital retired and relocated post 2 at Summit. They added head #22 and #24. 5-6-20 Capital are working at Summit Woods and Pryor. 5-5-20 Capital framed and set Post 5 at summit. 5-6-20 Capital assembled and set Post 1 on NW corner of of Summit Woods. They removed existing pole and equipment. Scott Koch instructed them to discard all material. 5-7-20 They worked on breaking out exiting foundations. They terminated Post 5 into cabinet.
Misc
Informational
07/08/2020
5-11-20 8:26am Capital are working on assembly of the poles at Pryor and Lowenstein. 5-13-20 They framed and set Post 1 and Post 4 at Lowenstein. 5-14-20 The rerouted street light cable at Summit Woods. They adjusted heads and wired cabinet at Lowenstein. 5-15-20 They installed fiber from Chipman to 470. 5-27-20 Capital will have the signal turn on for Pryor rd. And Lowenstein on June 4th at 9am. They will have Mid Am Signal, ETI, and Rythem on site for the cameras. It is possible they will have 4 pedestal poles not in operation yet. Sidewalks will play a factor. The signal will have a 2 week flash time. 6-4-20 9:25am Capital is on site with Scott Koch. They are testing the signals and will put them in flash mode for 14 days. 7-7-20 Capital have set pedestals at Lowenstein and are close to finishing. They installed at Lowenstein 1 8’ pedestal pole 4 15’ pedestal poles 6 pedestrian heads 6 push buttons 6 pedestrian signs Summit Woods 5 pedestrian heads 5 push buttons 5 pedestrian signs 7-9-20 11:44am Capital and Scott Koch are on site and have the signal at Pryor and Lowenstein working. They are now at Summit Woods and Pryor checking the signal. 1:50pm All signals are on and working.
Site Visit Partial 07/15/2020
Misc
Informational
07/15/2020
7-15-20 2:10pm I spoke with Codi and Kirk Middleton about getting the road blocks in place for private road C and A. I was told by both that they would do it. So far nothing has been done. I spoke with Brinkmann about keeping there crews from using the roads. Brinkmann should only be using C road off Lowenstein.
Site Visit Partial 07/16/2020
Misc
Informational
07/15/2020
7-15-20 2:10pm I spoke with Codi and Kirk Middleton about getting the road blocks in place for private road C and A. I was told by both that they would do it. So far nothing has been done. I spoke with Brinkmann about keeping there crews from using the roads. Brinkmann should only be using C road off Lowenstein. 7-16-20 ESS has placed road block signs in front of private road C and A.
Sidewalk Inspection Partial 8/12/2020 8/12/2020 08/12/2020
Misc
Informational
07/02/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor. 6-19-20 On 6-17-20 ESS poured the sidewalks on the east side of Lowenstein and Pryor. 6-30-20 7:28am ESS have poured sidewalk from Lowenstein heading north to private rd C. They are now setting up for the ADA at road C. 2:19pm ESS is pouring the sidewalk at the Southwest corner of Private Rd C. They are getting there concrete from PCI. 7-2-20 ESS are going to try to pour two ADA ramps today. 8-12-20 10:26am ESS is on site pouring the sidewalk on the West side of Pryor from private road A to private road C. They know to stay ADA compliant and to use plenty of cure.
Sidewalk Inspection Passed 8/17/2020 8/17/2020 08/17/2020
Misc
Informational
08/12/2020
6-11-20 1:54pm ESS has set up and are pouring sidewalk on the East side of Lowenstein and Pryor. 6-19-20 On 6-17-20 ESS poured the sidewalks on the east side of Lowenstein and Pryor. 6-30-20 7:28am ESS have poured sidewalk from Lowenstein heading north to private rd C. They are now setting up for the ADA at road C. 2:19pm ESS is pouring the sidewalk at the Southwest corner of Private Rd C. They are getting there concrete from PCI. 7-2-20 ESS are going to try to pour two ADA ramps today. 8-12-20 10:26am ESS is on site pouring the sidewalk on the West side of Pryor from private road A to private road C. They know to stay ADA compliant and to use plenty of cure. 8-17-20
ESC - (Vegetation/Ground Cover) Partial 08/19/2020
Misc
Informational
08/19/2020
8-19-20 Gordon is placing matting down on the north side of private road A.
Curb - Proof Roll Passed 09/01/2020
Street - Surface Course Passed 09/04/2020
Misc
Informational
07/01/2020
Misc
Informational
07/01/2020
6-28-20 5:36pm Metro is laying asphalt in the turning lanes on Pryor. They are using Type 5. 7:40pm They are done laying the surface asphalt. 6-30-20 2:14pm K&G Striping have started laying out Pryor Rd. Stripes. 7-1-20 1:35pm Metro Asphalt is filling in the seem at the Private Rd drive and Pryor.
Pavement-Surface Passed 09/04/2020
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C.
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C. They have started laying asphalt on the turn lane for Summit Woods.
Misc
Informational
06/09/2020
6-9-20 8:28am The asphalt crew have arrived and are getting set up to lay asphalt on all three turn lanes on Pryor. They will put down base on Private Rd C. They have started laying asphalt on the turn lane for Summit Woods. Metro Asphalt has the base on all three turn lanes on Pryor and are working on Private Rd C. CFS is on site for all testing.
Pavement-Proof Roll Passed 09/04/2020
Misc
Informational
06/08/2020
5-13-20 8:59am ESS proof rolled Two turn lanes on Pryor rd. They have both passed. Rain is moving in and the lanes will require a second proof roll with any rain fall. 6-8-20 We have proof rolled both turn lanes on Pryor and the drive at Pryor and Summit Wood. Private road C has passed as well.
Street - Repairs Passed 6/11/2020 6/11/2020 09/04/2020
Misc
Informational
04/03/2020
4-3-20 8:35am They have the turn lane on Pryor for Summit Woods rocked with geogrid. We will be proof rolling at a later date. They have removed the temporary asphalt base at the intersection of Pryor and Summit Woods and filled in with rock for now.
Misc
Informational
04/09/2020
4-9-20 8:53am They have Base rock in both turning lanes on Pryor. We will be proof rolling at a later date.
Misc
Informational
04/09/2020
4-9-20 8:53am They have Base rock in both turning lanes on Pryor. We will be proof rolling at a later date.
Misc
Informational
04/15/2020
4-15-20 ESS is still cutting grade for the road.
Misc
Informational
04/15/2020
4-15-20 ESS is still cutting grade for the road.
Misc
Informational
04/17/2020
4-15-20 ESS is still cutting grade for the road.
Misc
Informational
05/01/2020
5-1-20 The turn lanes have geo grid and base rock. They are cut and are ready for a proof roll.
Misc
Informational
05/01/2020
5-1-20 The turn lanes have geo grid and base rock. They are cut and are ready for a proof roll.
Misc
Informational
05/04/2020
5-1-20 The turn lanes have geo grid and base rock. They are cut and are ready for a proof roll. 5-29-20 They have poured the nose of the island at Summit Wood and Pryor. They are pumping out water in the turn lanes from yesterdays rain. 6-11-20 2:07pm Metro has installed a second lift in two of the three turn lanes.
Street - Striping Passed 09/04/2020
Storm - Material Verification Passed 09/04/2020
Install Street and Stop Signs Passed 09/04/2020
Storm - Outlet Structure Passed 09/04/2020
Storm - Inlets Clean Passed 09/04/2020
Storm - Pipe Passed 09/04/2020
Storm - Material Verification Passed 09/04/2020
Curb - Compression Strength Passed 09/04/2020
Install Street and Stop Signs Passed 09/04/2020
Grading/Excavation/Fill Inspection Passed 09/04/2020
Documents & Images
Date Uploaded File Type Document Name
12/16/2019 Receipt Receipt for transaction: 2019-007726
12/30/2019 signed permit 3625
03/30/2020 Letter DE-Permit
03/30/2020 Letter INSPECTION SUMMARY
04/01/2020 Pole pad NE corner
04/01/2020 Letter INSPECTION SUMMARY
04/03/2020 Letter INSPECTION SUMMARY
04/08/2020 Letter INSPECTION SUMMARY
04/09/2020 Letter INSPECTION SUMMARY
04/10/2020 Letter INSPECTION SUMMARY
04/13/2020 Letter INSPECTION SUMMARY
04/14/2020 Letter INSPECTION SUMMARY
04/15/2020 Letter INSPECTION SUMMARY
04/15/2020 Pole steel
04/15/2020 SW corner Lowenstein
04/15/2020 NW corner Lowenstein
04/16/2020 Letter INSPECTION SUMMARY
04/21/2020 Letter INSPECTION SUMMARY
04/29/2020 Letter INSPECTION SUMMARY
05/01/2020 Letter INSPECTION SUMMARY
05/06/2020 Letter INSPECTION SUMMARY
05/11/2020 Letter INSPECTION SUMMARY
05/12/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/18/2020 Letter INSPECTION SUMMARY
05/22/2020 Maple and main manhole
05/27/2020 Letter INSPECTION SUMMARY
06/04/2020 Letter INSPECTION SUMMARY
06/08/2020 Letter INSPECTION SUMMARY
06/09/2020 Letter INSPECTION SUMMARY
06/11/2020 Letter INSPECTION SUMMARY
06/19/2020 Letter INSPECTION SUMMARY
06/28/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
06/30/2020 Letter INSPECTION SUMMARY
07/01/2020 Letter INSPECTION SUMMARY
07/02/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/08/2020 Letter INSPECTION SUMMARY
07/09/2020 Letter INSPECTION SUMMARY
07/09/2020 Letter INSPECTION SUMMARY
07/15/2020 Letter INSPECTION SUMMARY
07/16/2020 Letter INSPECTION SUMMARY
08/19/2020 Letter INSPECTION SUMMARY
09/08/2020 Letter DE-Certificate of Substantial Completion Multiple Lot
09/08/2020 Letter DE-Punch List
02/28/2024 Final Affidavit 2_28_24 NW Pryor Rd Signal Improvements Lane Widening - ESS Executed
02/29/2024 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:





Portal Home
