Summary

PRSUBD20191872
Public Infrastructure
Final Acceptance
CMH PARKS INC
DEVELOPMENT COMPLETE
MANOR AT STONEY CREEK 4TH PLAT SUBDIVISION IMPROVEMENTS
07/15/2019
10/15/2019
05/18/2023
Locations
Address
4401 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4405 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4409 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4413 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4417 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4421 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4420 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4416 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4412 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4408 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4404 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
4400 SW GRINDSTONE CIR, LEES SUMMIT, MO 64082

Address
1936 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1932 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1928 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1924 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1920 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1912 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1908 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1909 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1913 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1917 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1921 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1925 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1929 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1933 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Address
1937 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Property
69700110300000000

Property
69700110400000000

Property
69700110500000000

Property
69700126400000000

Property
69700110600000000

Property
69700126300000000

Property
69700110700000000

Property
69700125100000000

Property
69700125200000000

Property
69700126200000000

Property
69700125000000000

Property
69700125300000000

Property
69700110800000000

Property
69700126100000000

Property
69700125400000000

Property
69700124900000000

Property
69700110900000000

Property
69700126000000000

Property
69700125500000000

Property
69700124800000000

Property
69700111000000000

Property
69700125900000000

Property
69700125600000000

Property
69700124700000000

Property
69700111100000000

Property
69700125800000000

Property
69700124600000000

Property
69700125700000000

Address
1905 SW MERRYMAN DR, LEES SUMMIT, MO 64082

Contacts
Not shown for privacy reasons.
CMH PARKS INC, Address:5000 CLAYTON RD
WILLIAMS CECIL & TANIA, Address:1909 SW MERRYMAN DR
LIVINGSTON SCOTT M & VIRGINIA LEE, Address:1905 SW MERRYMAN DR
VALENTIC TAMMY & CAROLINE, Address:1913 SW MERRYMAN DR
ROBERTS GERALD & TERRI, Address:1917 SW MERRYMAN DR
TWENTER CORNELIUS L & MARY P, Address:1921 SW MERRYMAN DR
AVITAL HOMES LLC, Address:7200 W 151ST ST #23100
PATHAK ABHISHEK & SIMRAN SHREE, Address:1929 SW MERRYMAN DR
DJ23 INVESTMENTS LLC, Address:7200 W 132ND ST
COSTANTINI MEGAN & MATTEO, Address:1908 SW MERRYMAN DR
ROGERS MARILYN SUE, Address:1912 SW MERRYMAN DR
GRAY MATTHEW & TINA, Address:1920 SW MERRYMAN DR
AVITAL HOMES LLC, Address:15729 BALLENTINE ST
RAIMONDI DANIEL, Address:1932 SW MERRYMAN DR
DECKER RYAN LEE & ELIZABETH ANNE, Address:1936 SW MERRYMAN DR
TATCHIM IVAN & KAMNO FOTSO MICHELLE CYNTHIA, Address:4400 SW GRINDSTONE CIR
PULLIAM MICHELLE, Address:4404 SW GRINDSTONE CIR
RAY JACOB WILLIAM & RACHEL KATHLEEN, Address:4408 SW GRINDSTONE CIR
WILSON DYLAN JACOBS & DUNWORTH KELCEY, Address:4412 SW GRINDSTONE CIR
ESKEW AUSTEN, Address:4416 SW GRINDSTONE CIR
MEIRIES JENNIFER & SHELBY, Address:4401 SW GRINDSTONE CIR
SIMMON JOSHUA C & AMBER M, Address:4405 SW GRINDSTONE CIR
MCKAY LACEY MAE, Address:4409 SW GRINDSTONE CIR
BRADLEY JASON & JENNIFER, Address:4413 SW GRINDSTONE CIR
STARMAN KELSEY A, Address:4417 SW GRINDSTONE CIR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 07/15/2019 01/19/2021
Dawn Bell
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $2,931.60 $2,931.60 Paid 07/15/2019
91100C9-Water Insp Fee $1,793.88 $1,793.88 Paid 07/15/2019
9110068-Storm Fee $3,089.57 $3,089.57 Paid 10/03/2019
9110071-Site Grading Fee $1,622.50 $1,622.50 Paid 10/03/2019
9110081-Paved Surface Inspection Fee $5,019.49 $5,019.49 Paid 10/03/2019
Outstanding Fees Amount Paid Owing Date Paid
No outstanding fees.

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Sanitary Sewer Construction Inspection Partial 10/28/2019 10/28/2019
Misc
Informational
10/28/2019

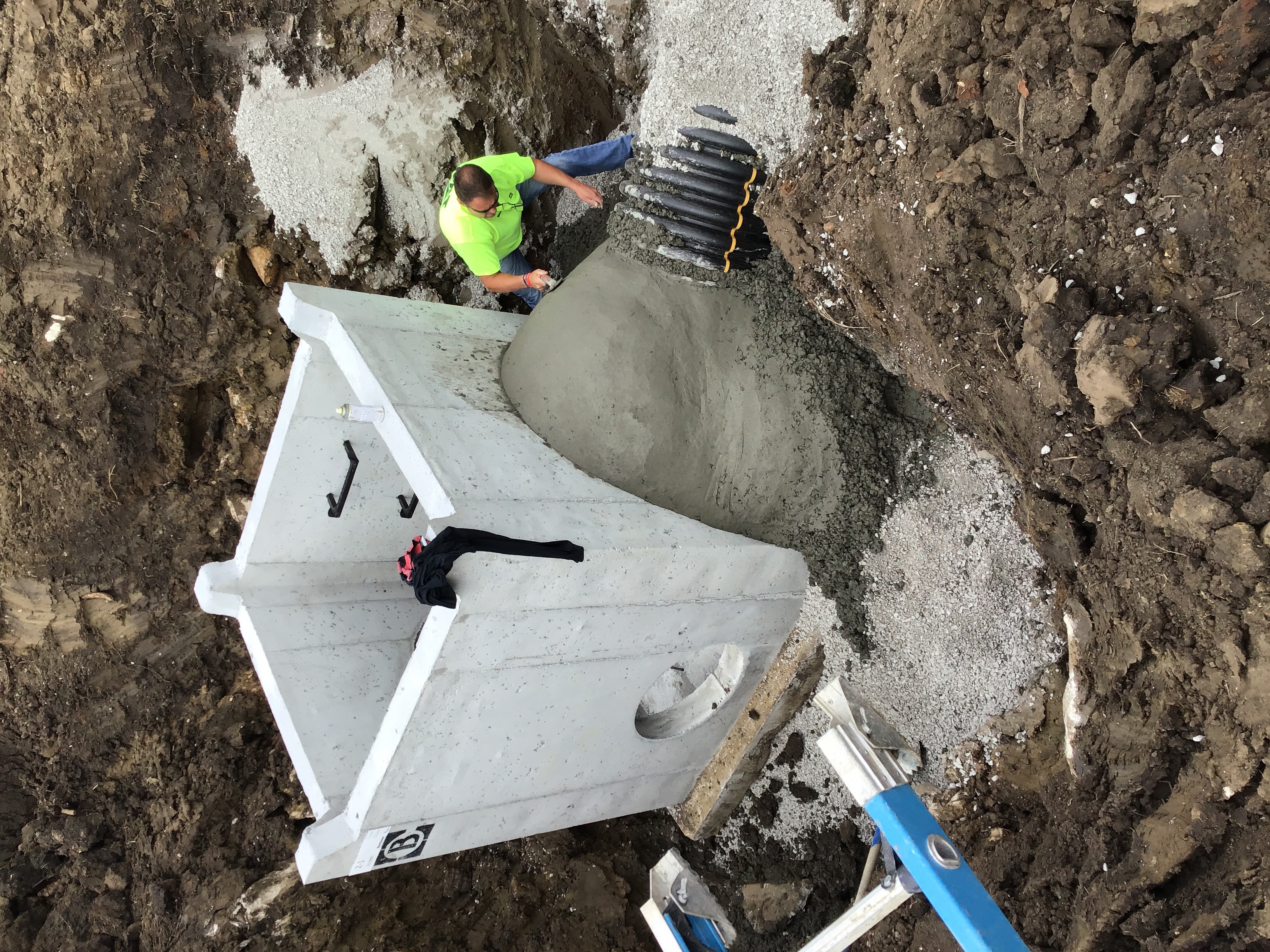

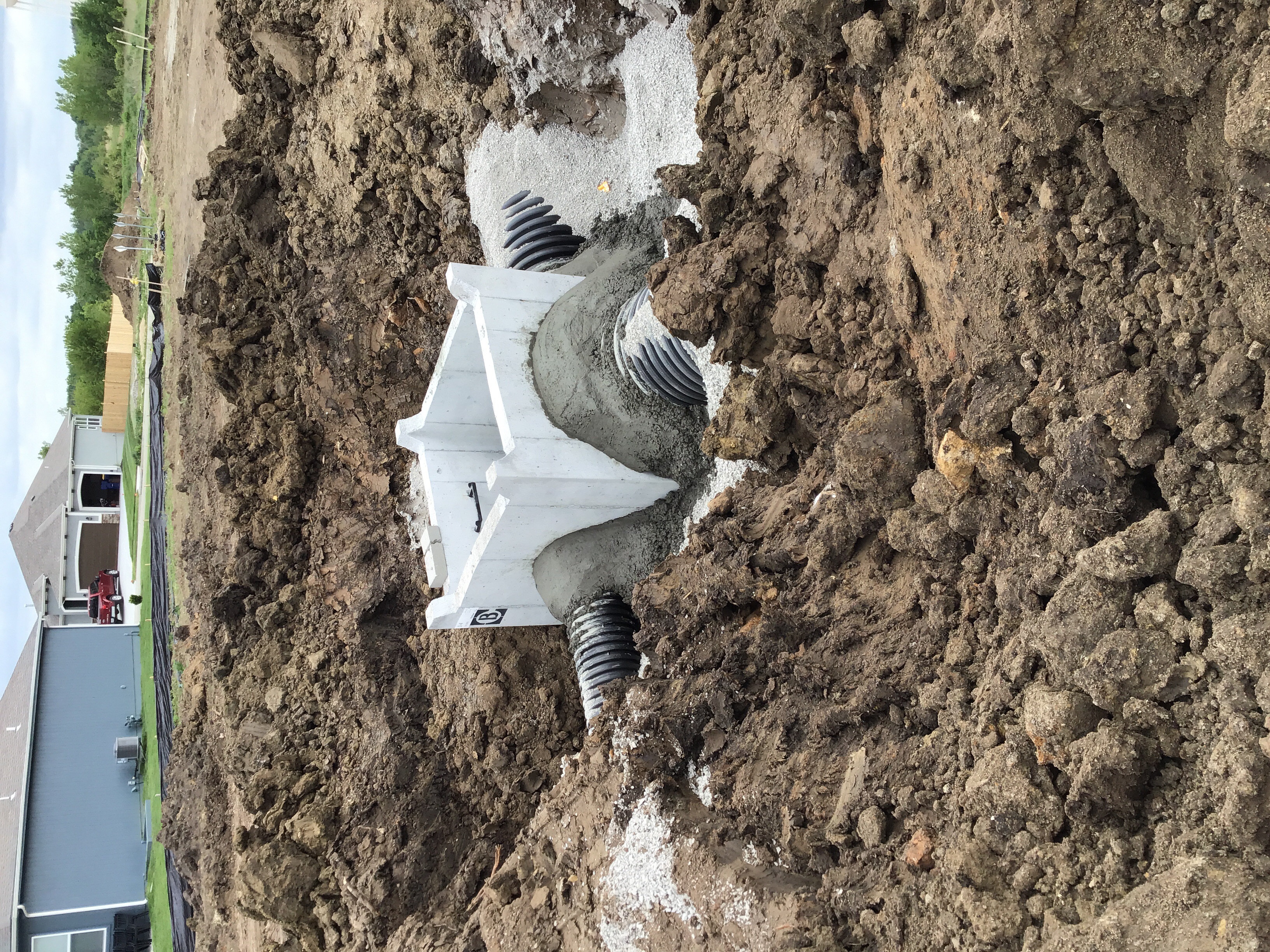

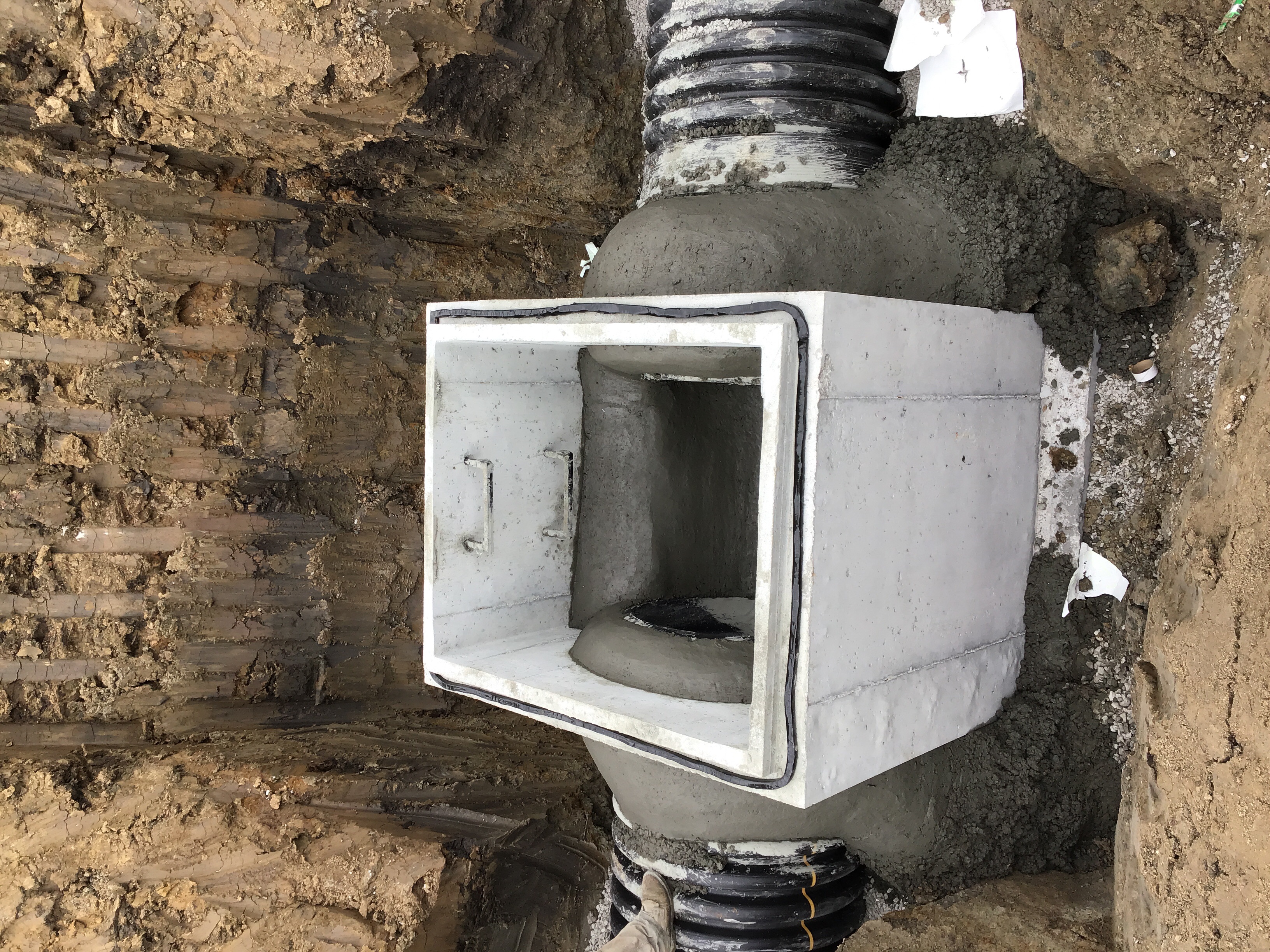

The Redford crew started the sanitary sewer install for Line A. The crew installed approximately 50’ ft of line from MH C-4. The first WYE fitting was installed for lot 128 and is right at 5’ft out from the existing MH. Photos of the work are uploaded.
Sanitary - Material Verification Passed 10/28/2019
Misc
Informational
10/28/2019
Sanitary Materials have been verified in compliance. Photos are uploaded.
Sanitary Sewer Construction Inspection Partial 10/29/2019
Misc
Informational
10/29/2019
The Redford crew is on site continuing the sanitary sewer install for line A. The crew set MH A-1 and ran approx. 150’ of the line. Photos are uploaded.

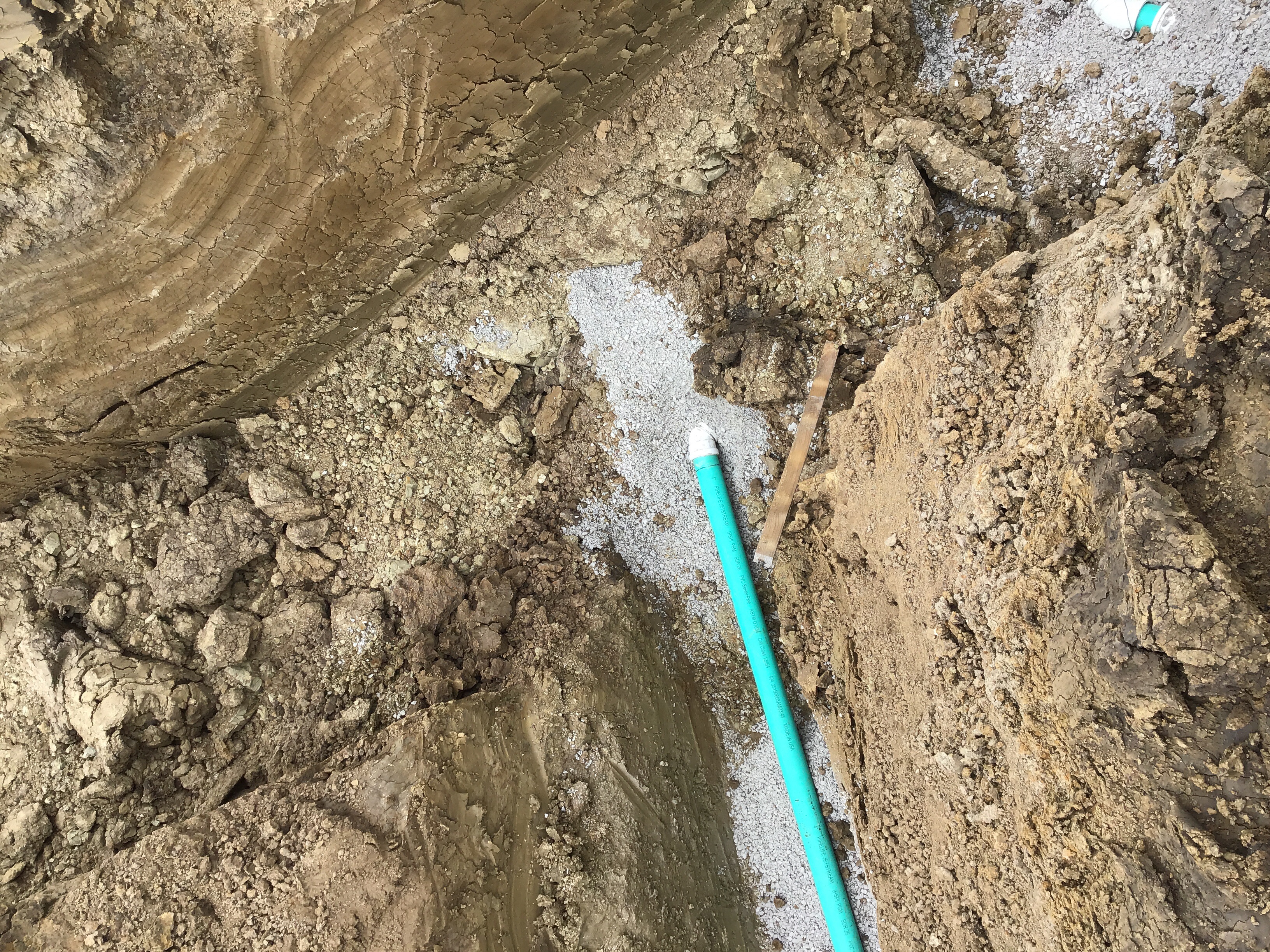

Erosion Control Inspection Failed 10/15/2019 03/19/2020
Miscellaneous Correction
Corrective Action Required
03/19/2020
FAILED EROSION CONTROL INSPECTION There are numerous areas on site where the silt fence has failed and is allowing silt and mud to leave the site. Make corrections to the erosion control devices asap to control the silt from leaving the site.
Sanitary Sewer Construction Inspection Partial 05/07/2020
Misc
Informational
05/07/2020

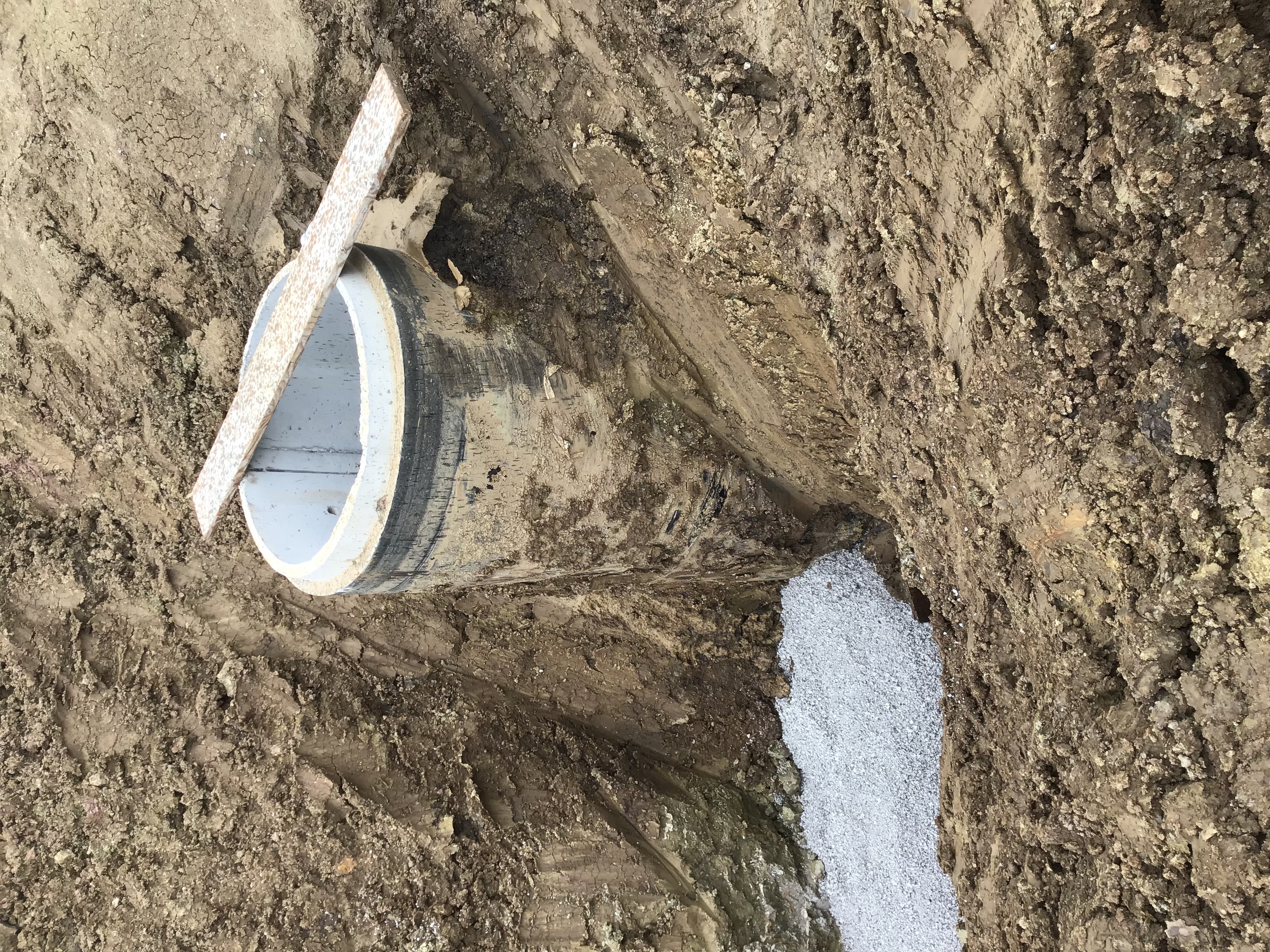

Redford Construction is on site installing Sanitary Line B. The crew stubbed out of MH B-1 and installed approx 365’ ft of the 8” main from station 1+00 to approx 3+65. Service stubs are installed for lots 109-111 & 118-120. Photos of the work are uploaded.
Sanitary Sewer Construction Inspection Partial 5/8/2020 05/11/2020
Misc
Informational
05/11/2020
The crew installed the remainder of Line B. The crew set MH B-2 and poured the invert for the MH. All service laterals for lots 109 - 120 are installed. The crew was preparing to pour the trench checks for the service laterals this afternoon. Photos of the work are uploaded into the system. I will return tomorrow for further inspection of the trench checks.
Sanitary Sewer Construction Inspection Partial 05/12/2020
Misc
Informational
05/11/2020
Redford Construction is on site installing Sanitary Line B. The crew stubbed out of MH B-1 and installed approx 365’ ft of the 8” main from station 1+00 to approx 3+65. Service stubs are installed for lots 109-111 & 118-120. Photos of the work are uploaded.
Misc
Informational
05/12/2020

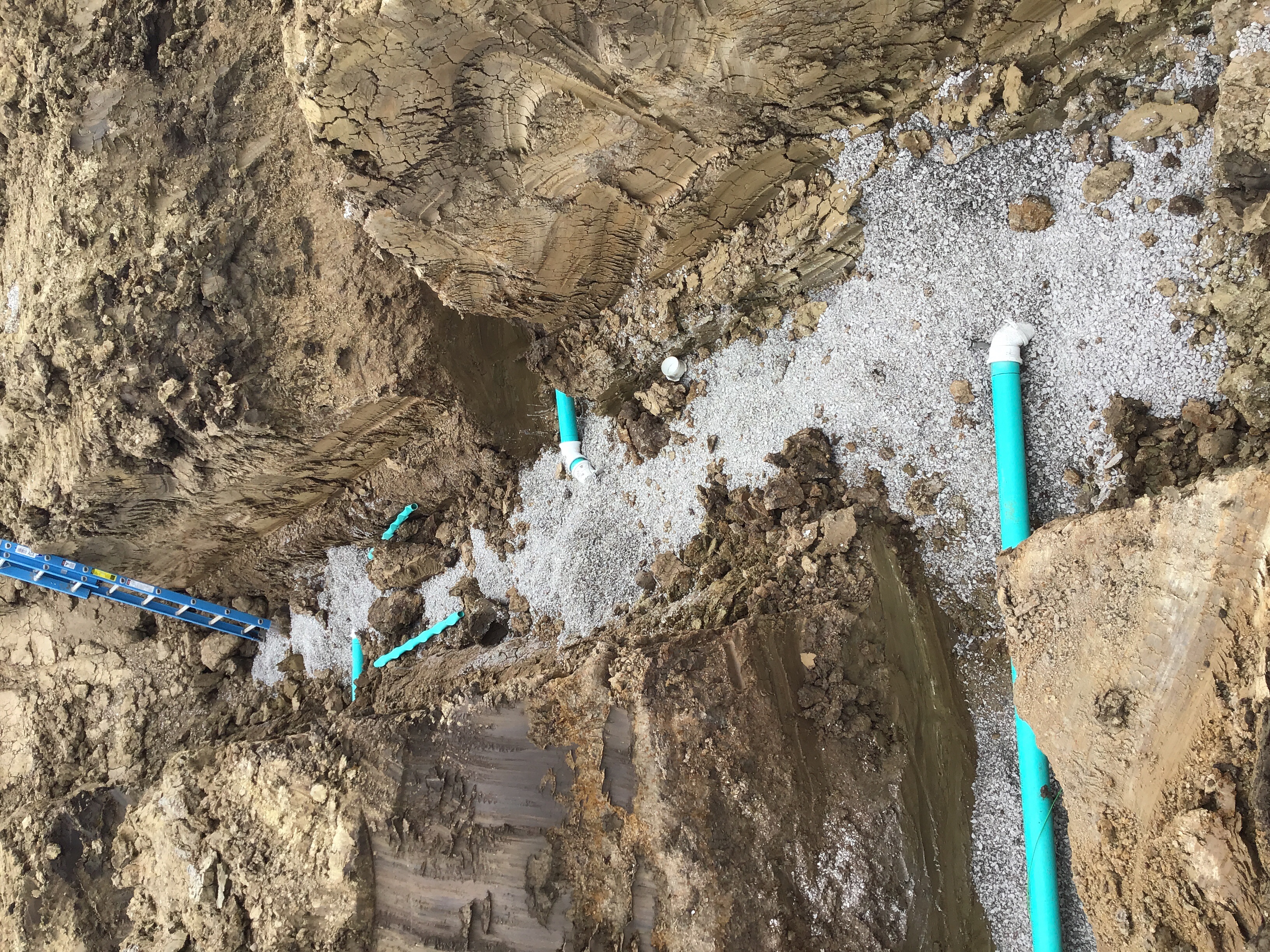

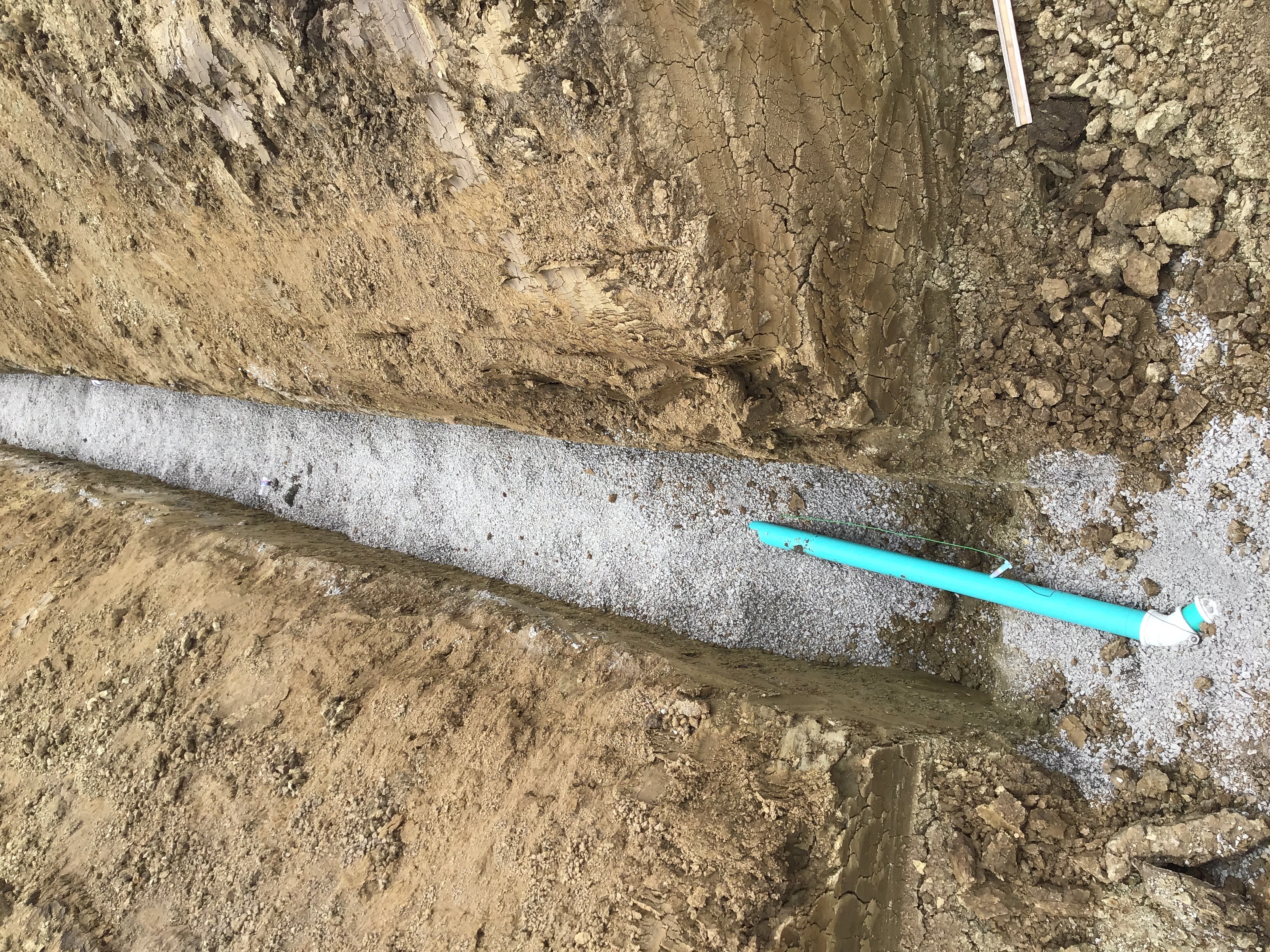

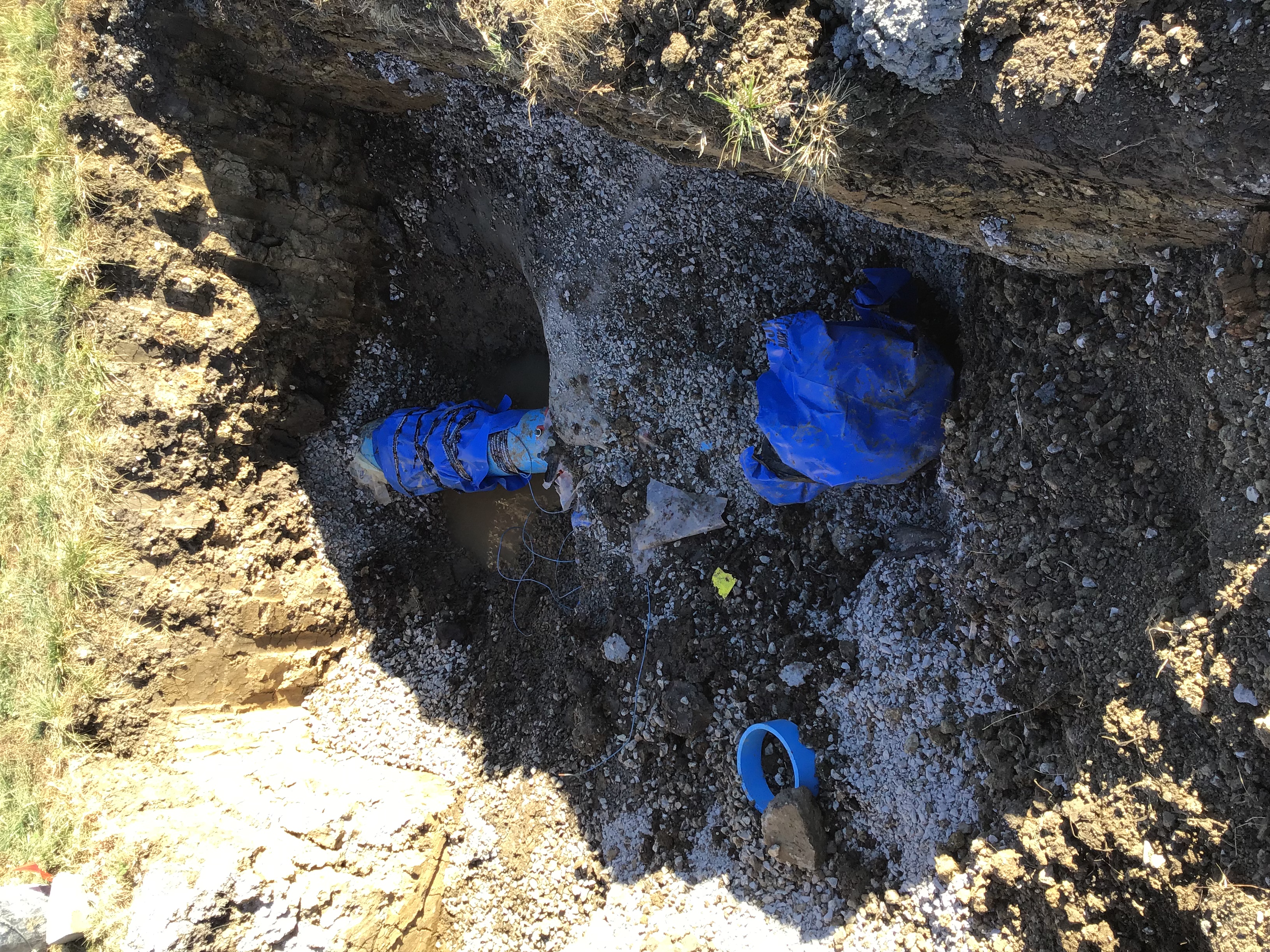

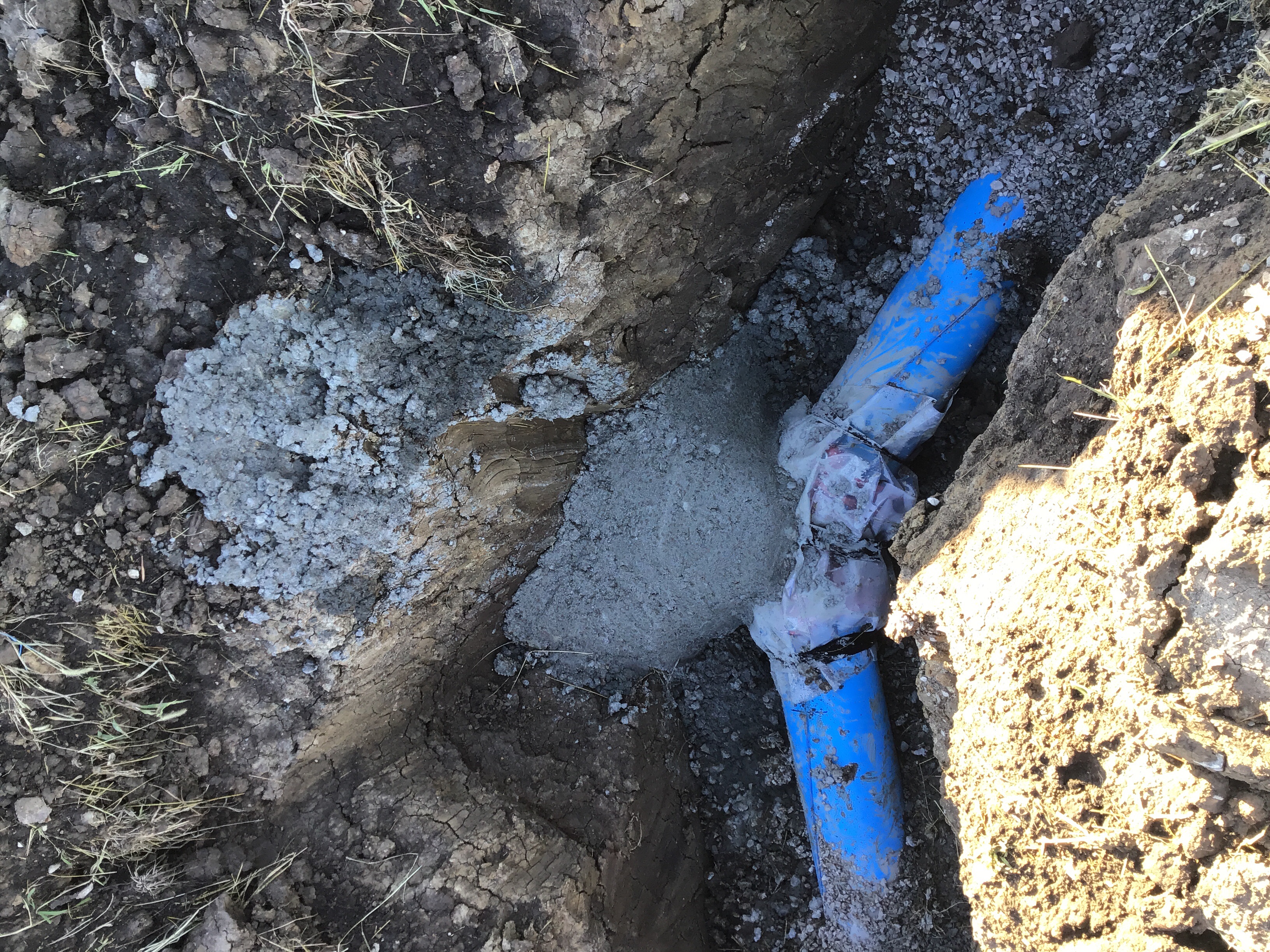

Trench checks for lots 109 - 120 were installed using flowable fill. The check sizes were sufficient. Photos have been uploaded.
Sanitary Sewer Construction Inspection Partial 05/12/2020
Misc
Informational
05/12/2020
Redford Construction is on site installing Sanitary Line B. The crew stubbed out of MH B-1 and installed approx 365’ ft of the 8” main from station 1+00 to approx 3+65. Service stubs are installed for lots 109-111 & 118-120. Photos of the work are uploaded.
Misc
Informational
05/12/2020
Trench checks for lots 109 - 120 were installed using flowable fill. The check sizes were sufficient. Photos have been uploaded.
Misc
Informational
05/12/2020
The Redford crew is currently backfilling the line and KCTE is on site getting the compaction testing for the street crossings.
Sanitary Sewer Construction Inspection Passed 05/13/2020
Misc
Informational
05/12/2020
Redford Construction is on site installing Sanitary Line B. The crew stubbed out of MH B-1 and installed approx 365’ ft of the 8” main from station 1+00 to approx 3+65. Service stubs are installed for lots 109-111 & 118-120. Photos of the work are uploaded.
Misc
Informational
05/12/2020
Trench checks for lots 109 - 120 were installed using flowable fill. The check sizes were sufficient. Photos have been uploaded.
Misc
Informational
05/12/2020
The Redford crew is currently backfilling the line and KCTE is on site getting the compaction testing for the street crossings.
Misc
Informational
05/13/2020
The sanitary sewer lines for both The Manor & Reserve at Stoney Creek are installed. We will be testing the sewer lines in 30 days.
Storm Sewer Construction Inspection Partial 05/13/2020
Misc
Informational
05/13/2020

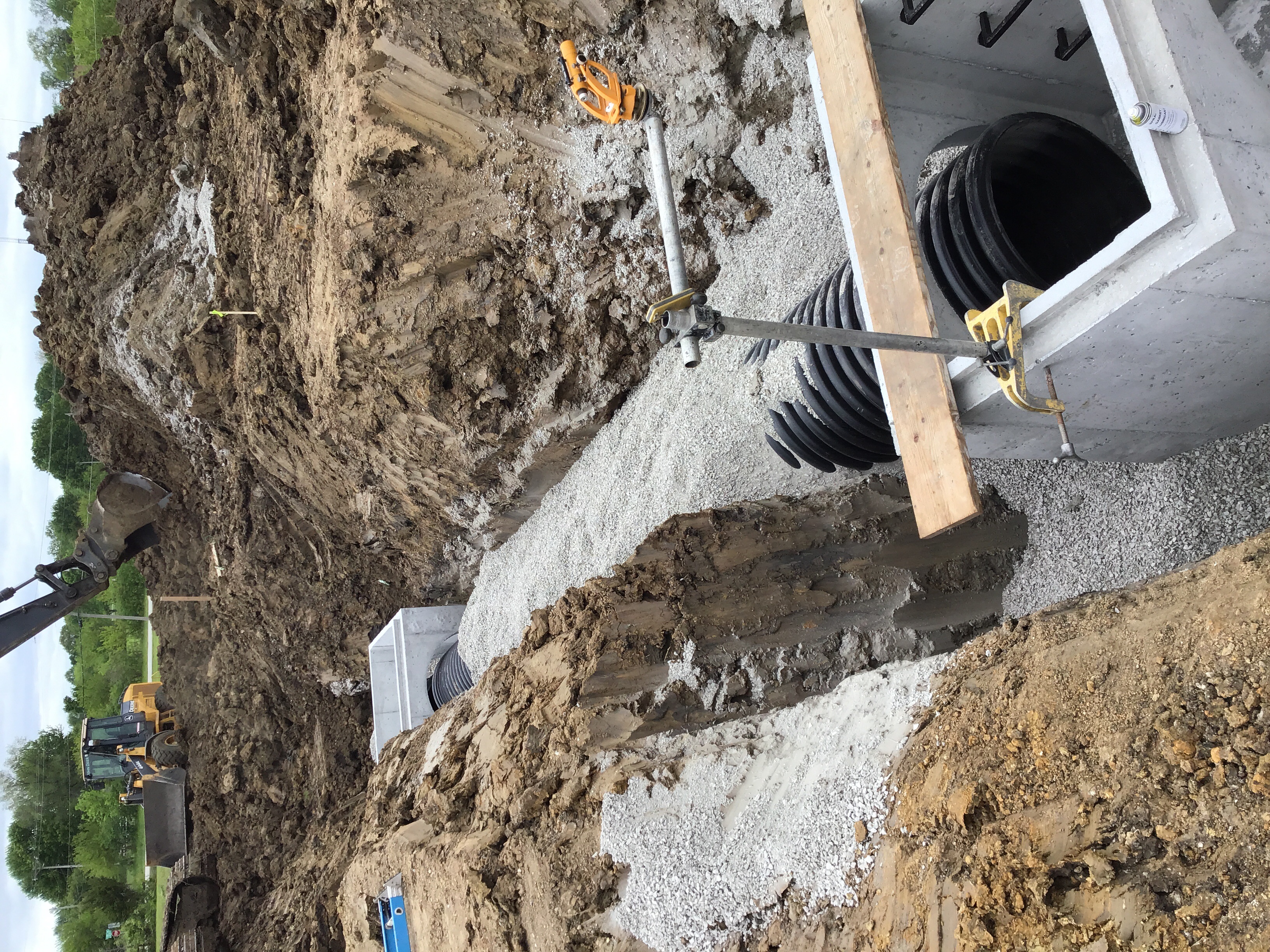

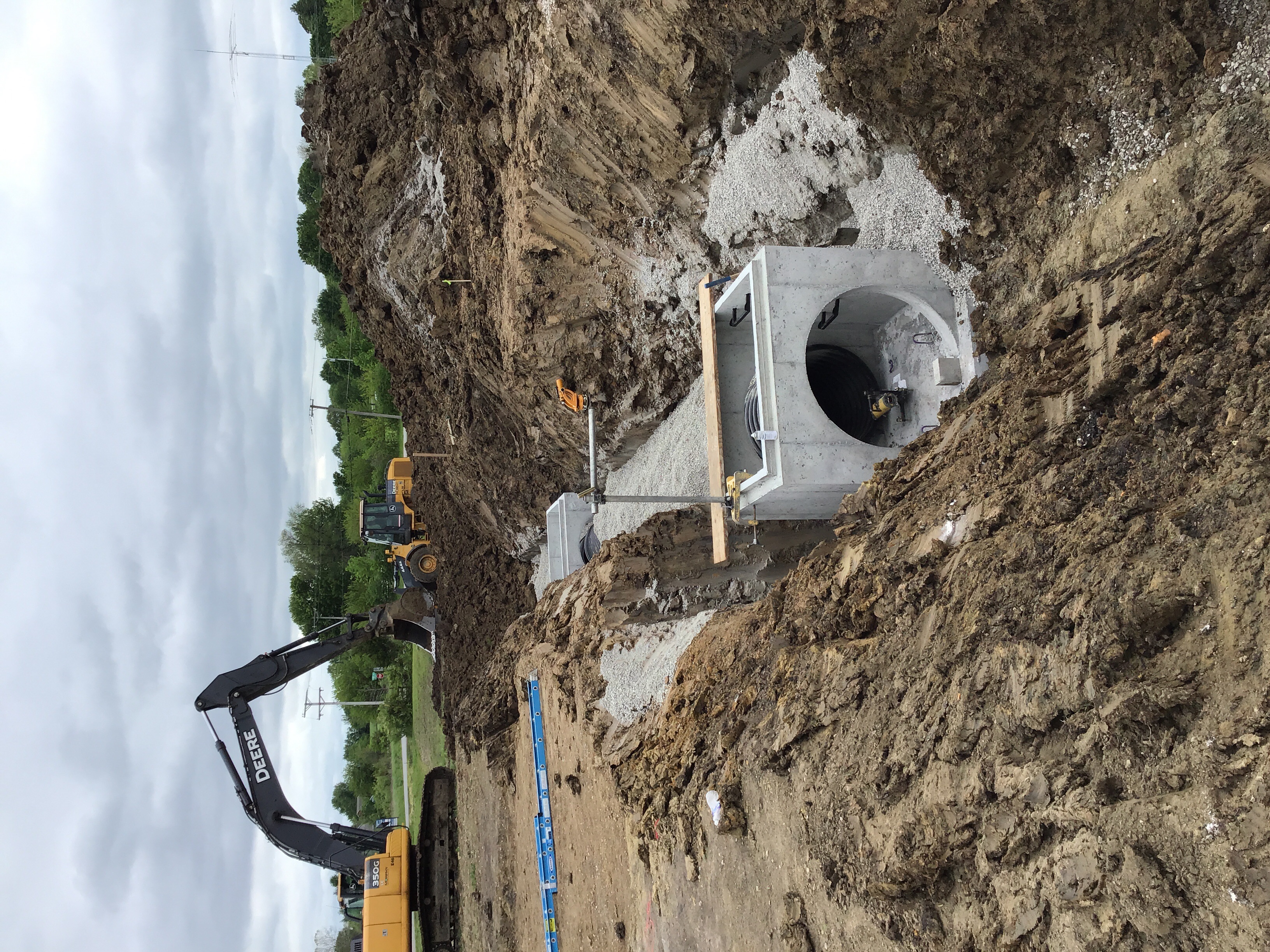

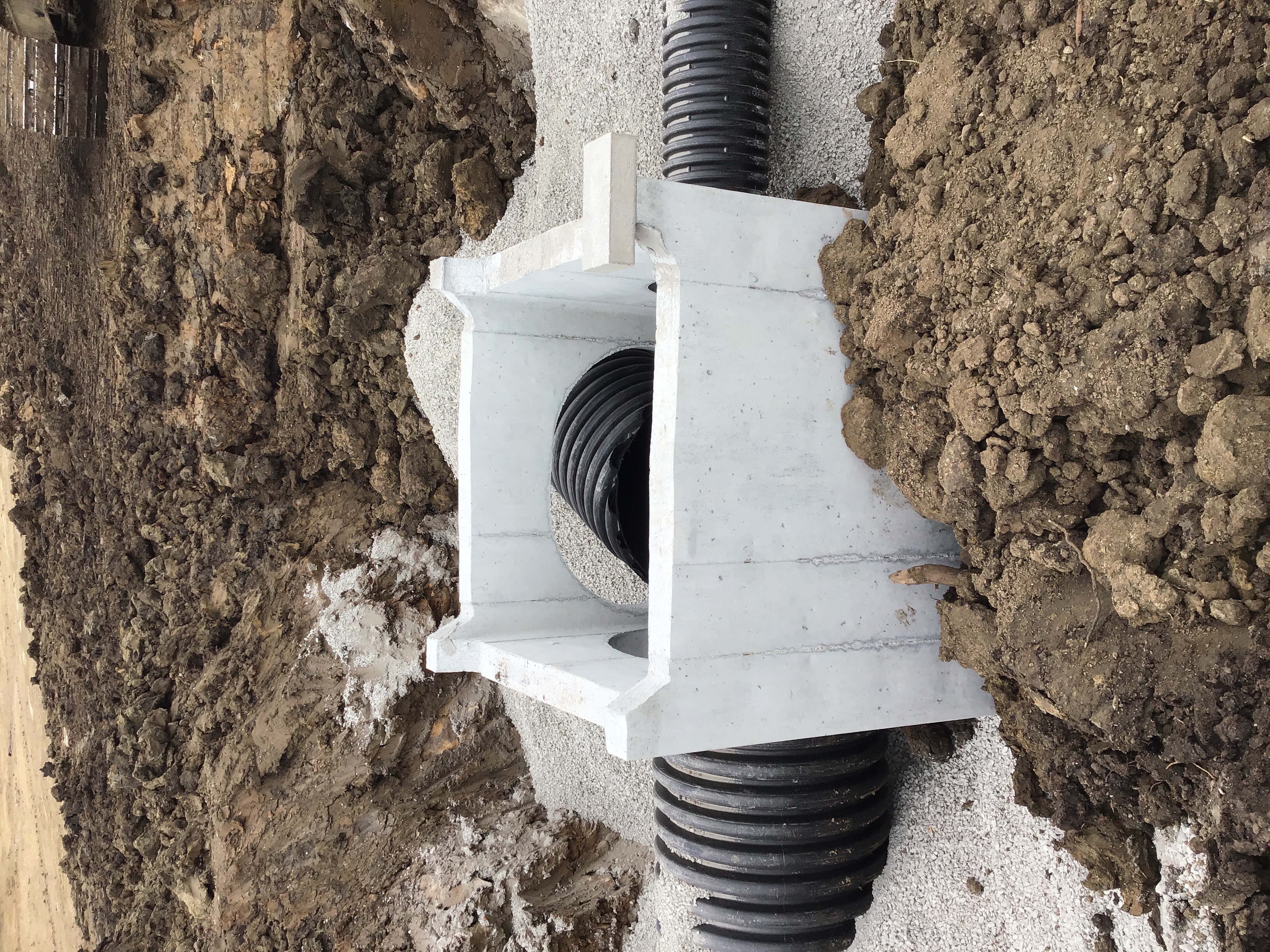

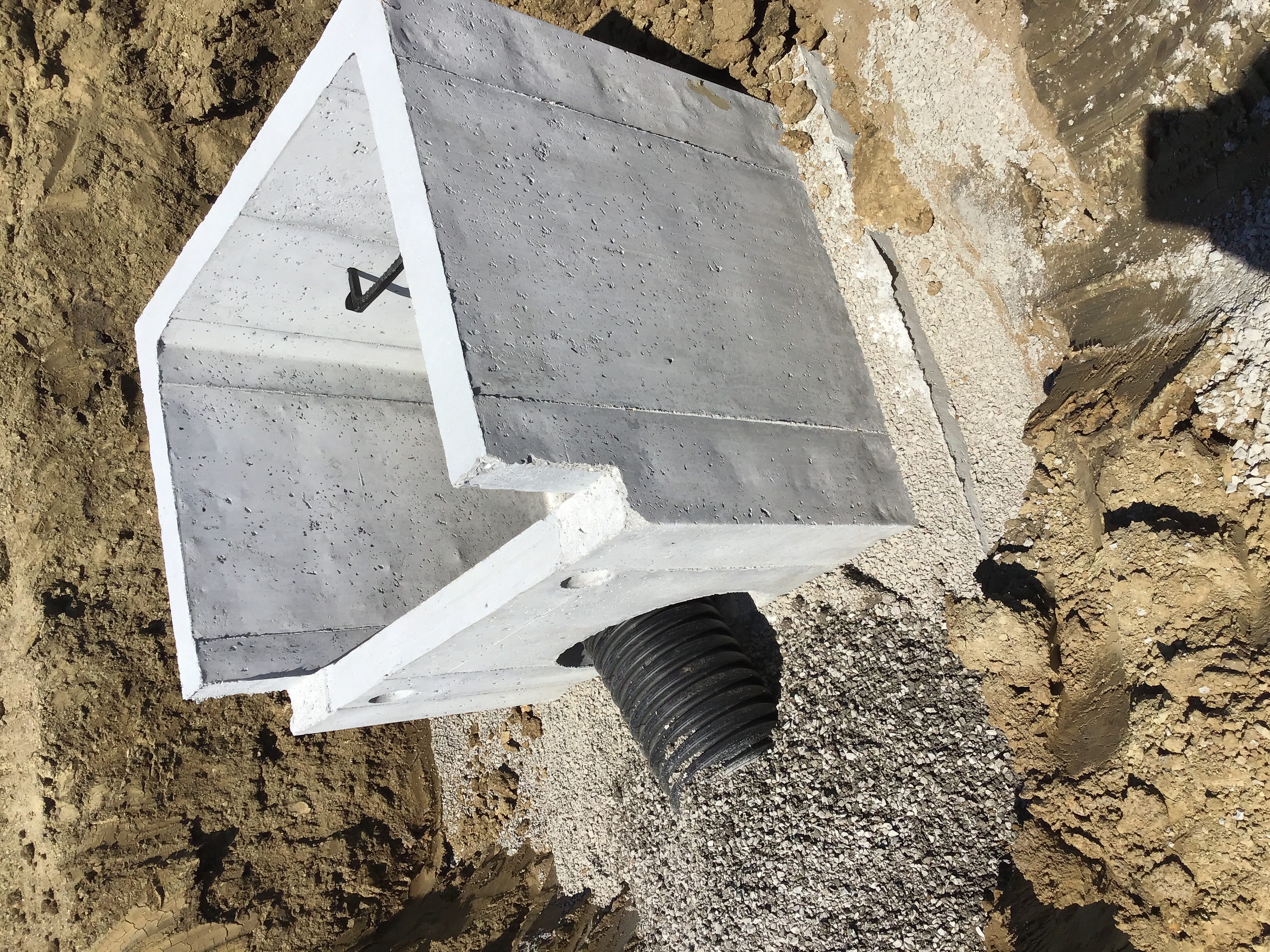

The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Storm Sewer Construction Inspection Partial 5/14/2020 05/14/2020
Misc
Informational
05/13/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/14/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Storm Sewer Construction Inspection Partial 05/14/2020
Misc
Informational
05/14/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/14/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/14/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Storm Sewer Construction Inspection Partial 05/18/2020
Misc
Informational
05/14/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/14/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/14/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/18/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Storm Sewer Construction Inspection Partial 05/18/2020
Misc
Informational
05/18/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/18/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/18/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/18/2020

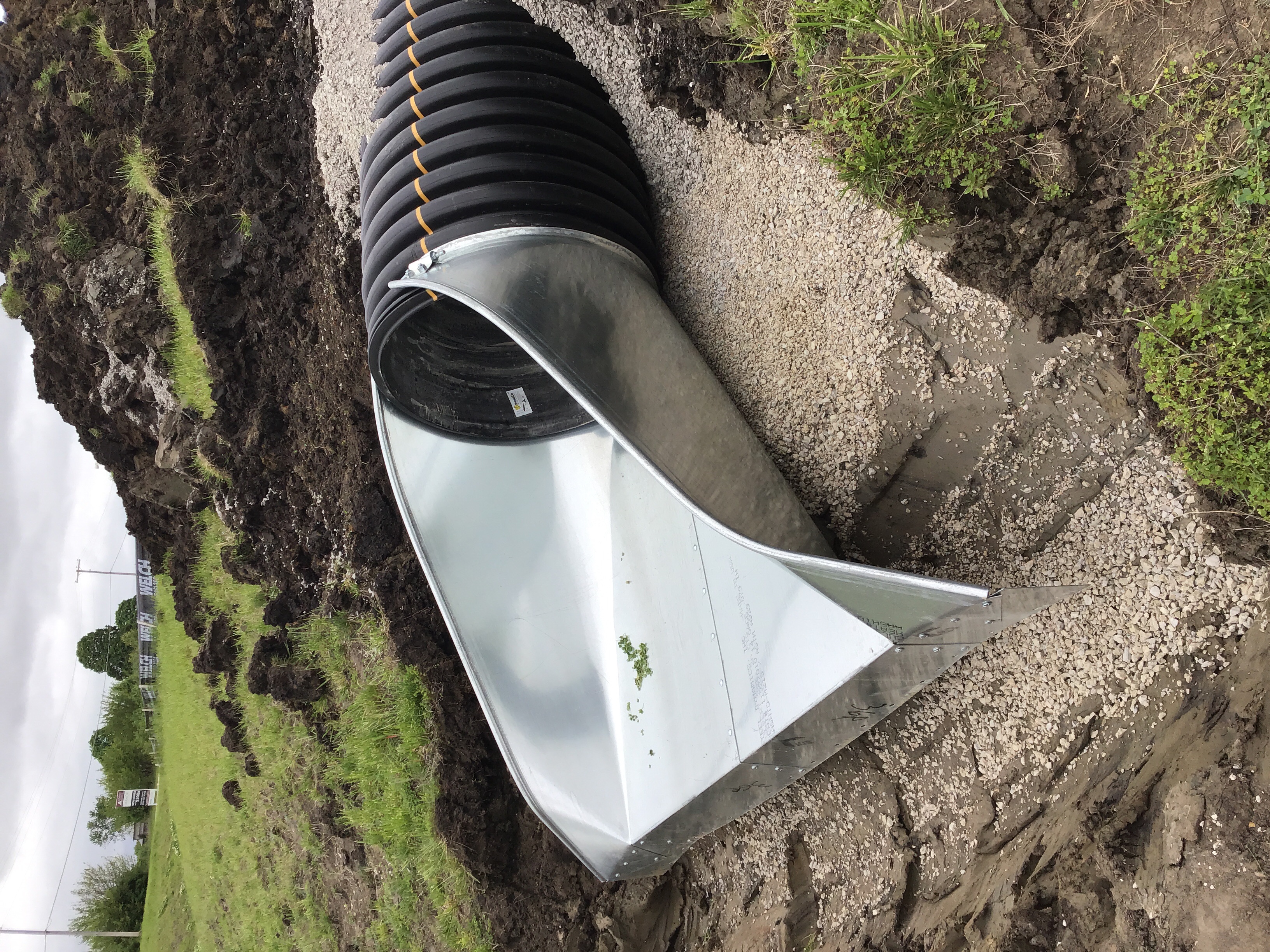

The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/18/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 05/19/2020
Misc
Informational
05/18/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/18/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/18/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/18/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/18/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
05/19/2020

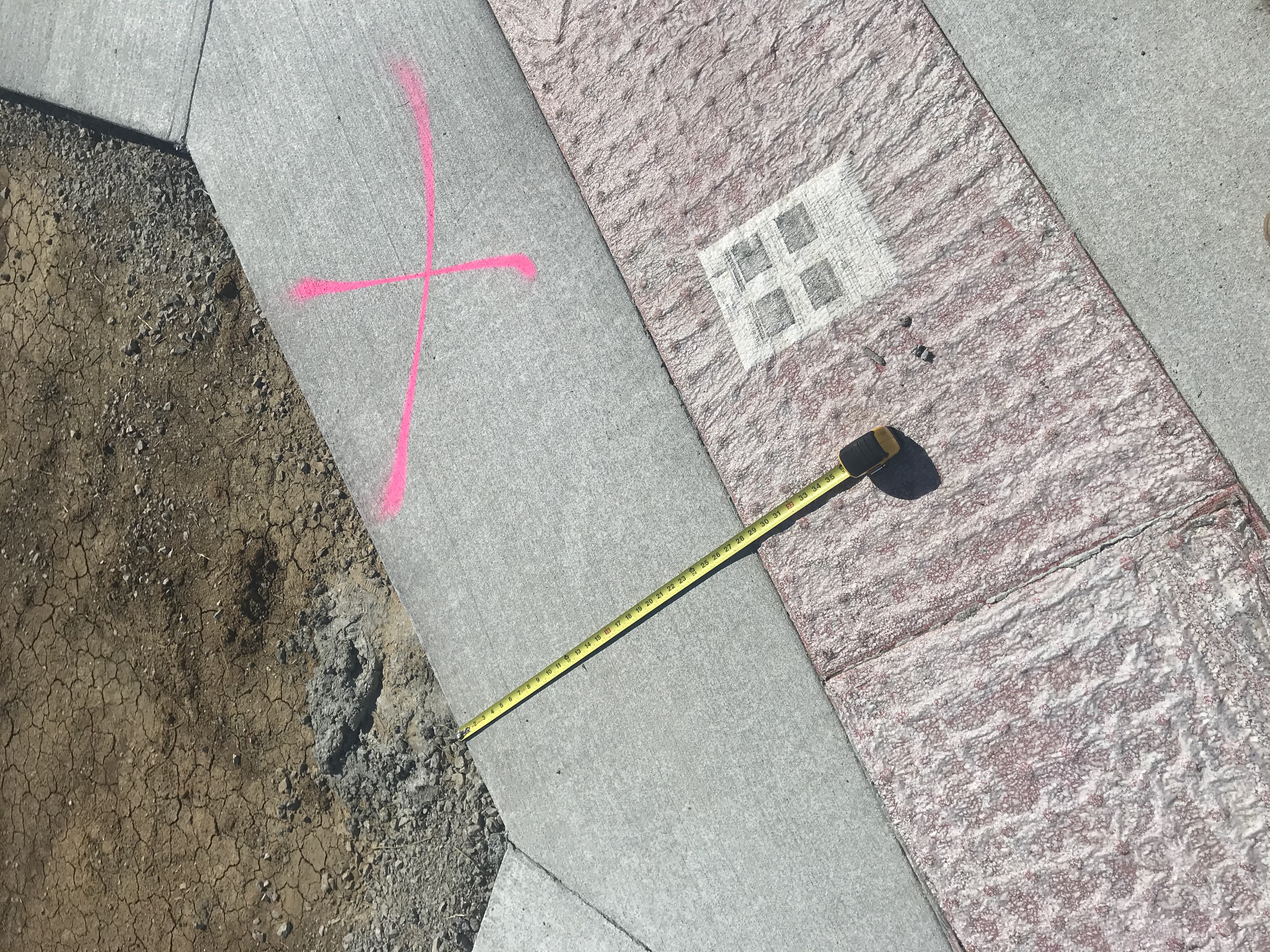

The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.

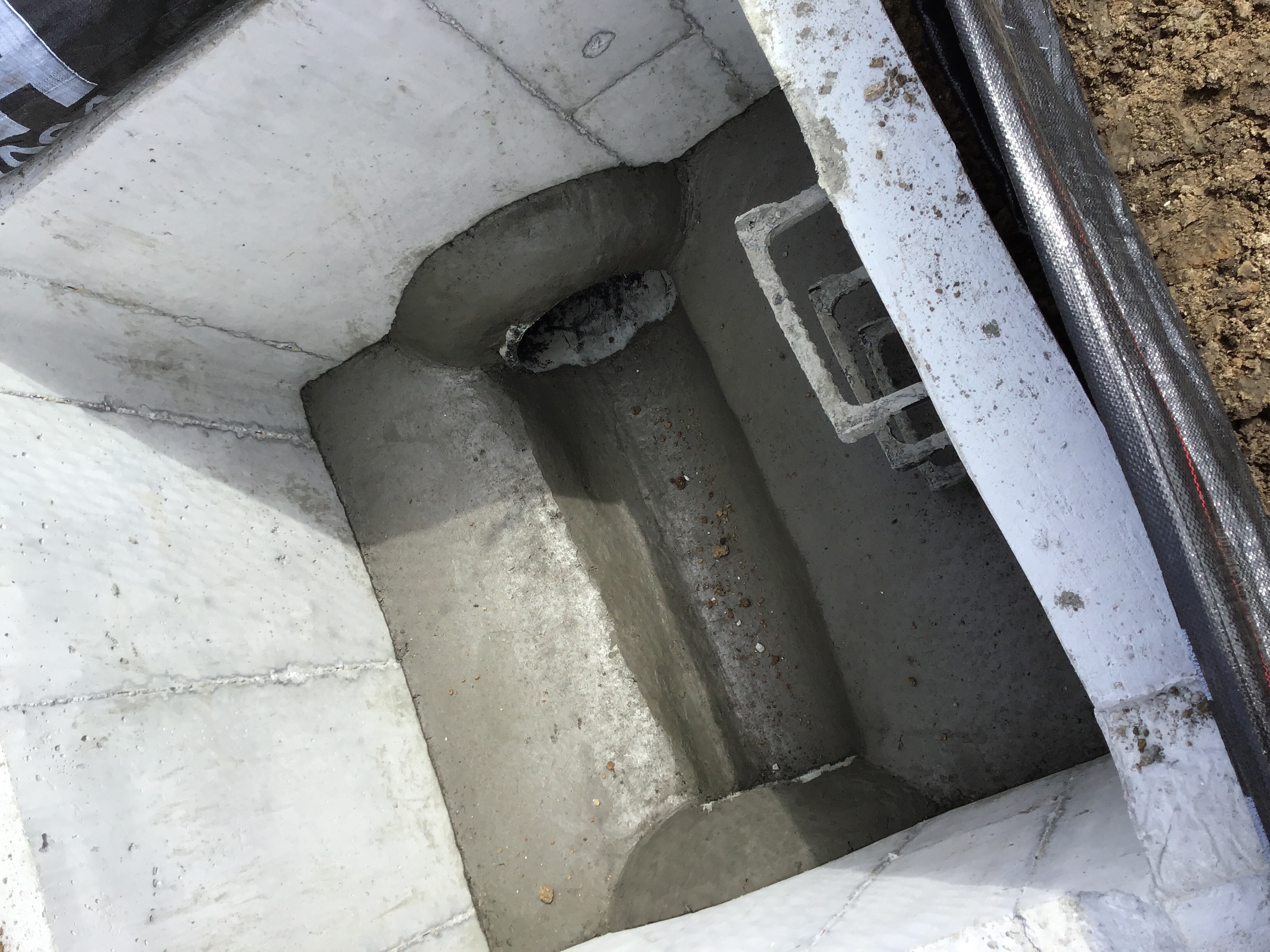

Sanitary Sewer - Wye / Insert-A-Tee Installation Passed 05/19/2020
Misc
Informational
05/19/2020

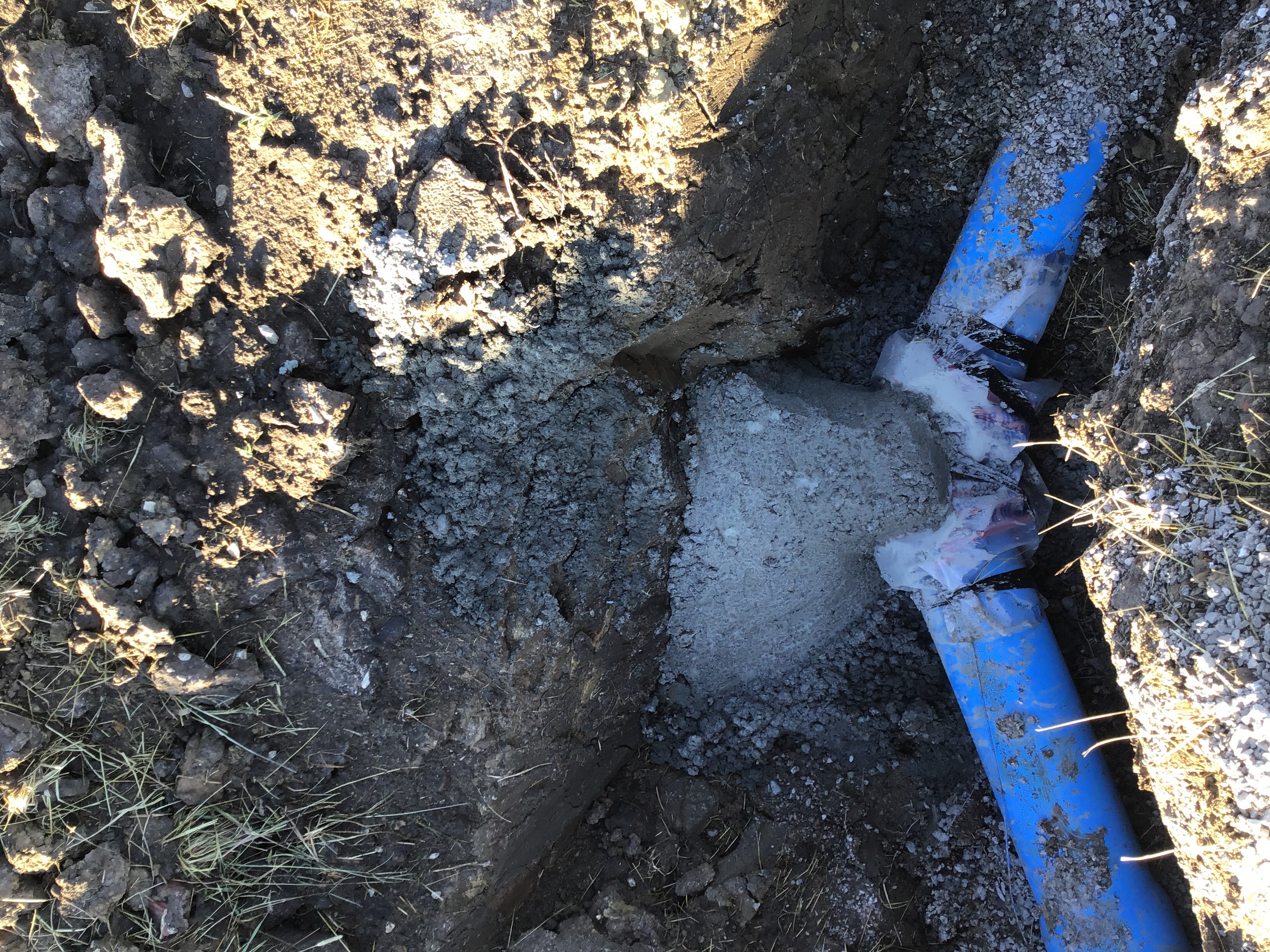

During the construction of Storm Line 1, the crew discovered that where Sanitary Line A crosses the storm line, the service lateral for lot 130 was set back 8’ ft short and was not going to allow for proper clearance between the storm and sanitary lines. After discussion with the water department the crew adjusted the service laterals to the correct stations and clearance was achieved. I verified the correct materials used for the correction (Strong-Back Fernco) and Lance Lewis from the water department was on site to inspect the correction as well.
Storm Sewer Construction Inspection Partial 05/20/2020
Misc
Informational
05/19/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/19/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/19/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/19/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/19/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
05/19/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
05/20/2020
The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Storm Sewer Construction Inspection Partial 05/21/2020
Misc
Informational
05/20/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/20/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/20/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/20/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/20/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
05/20/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
05/20/2020

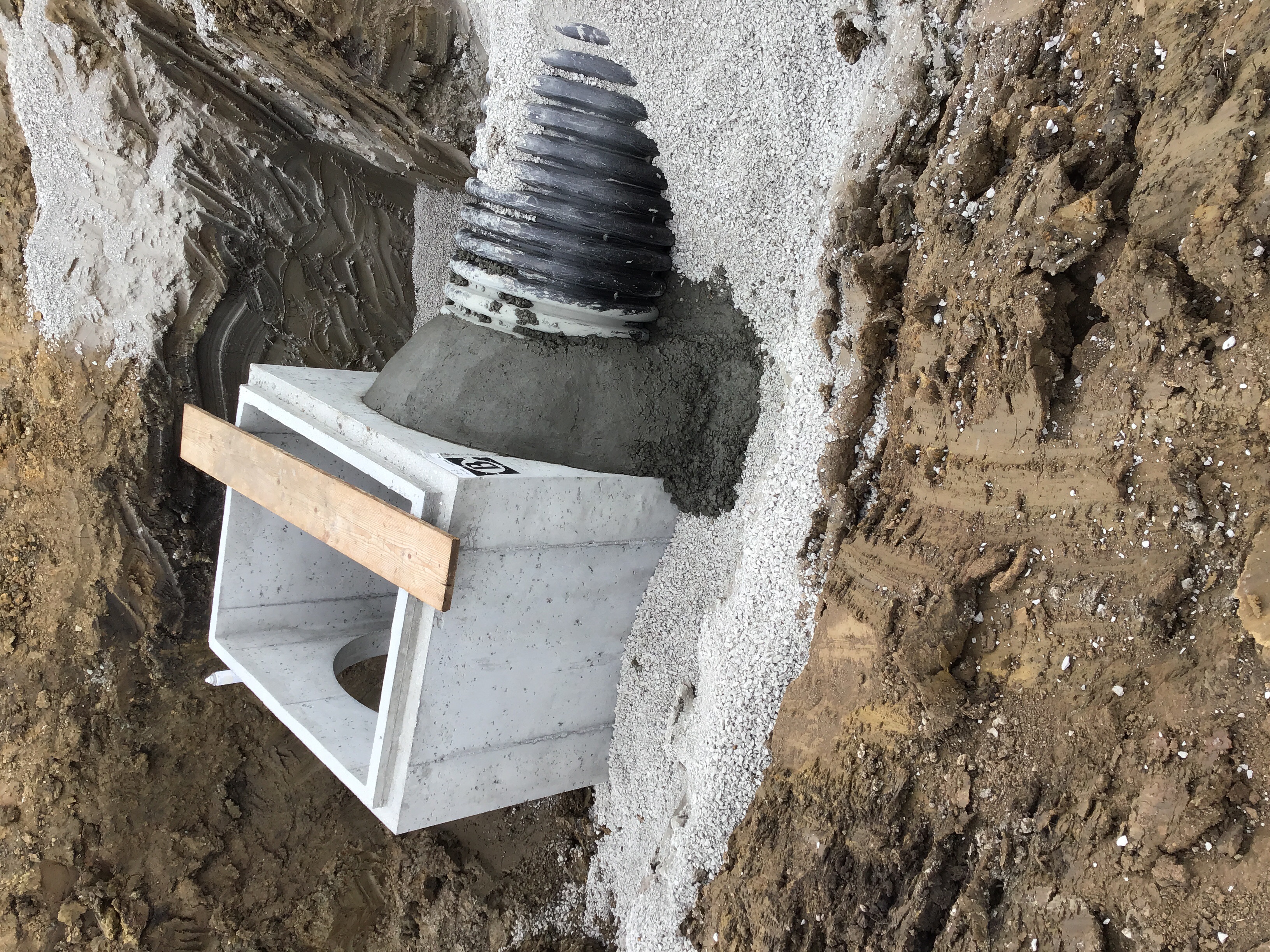

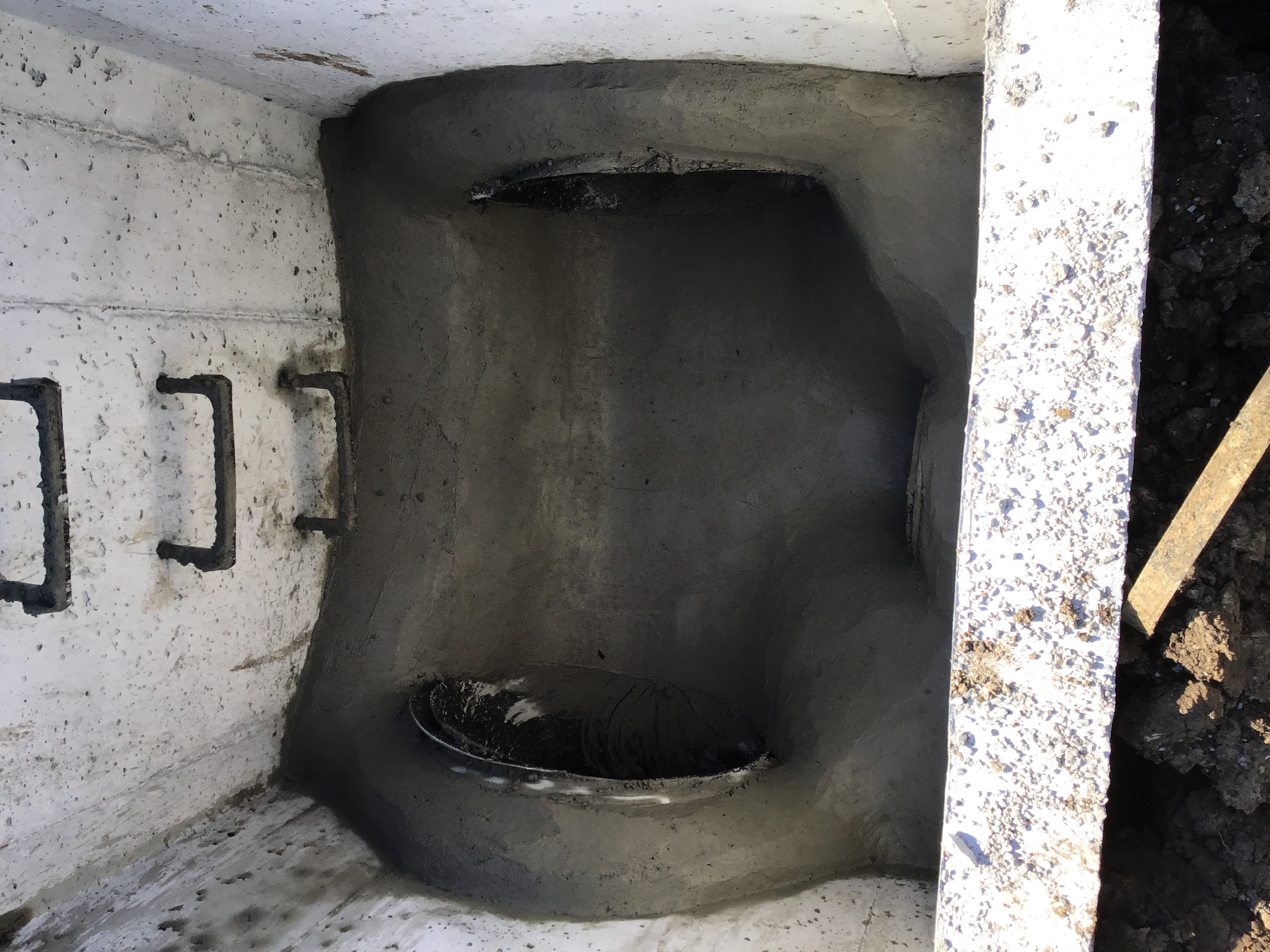

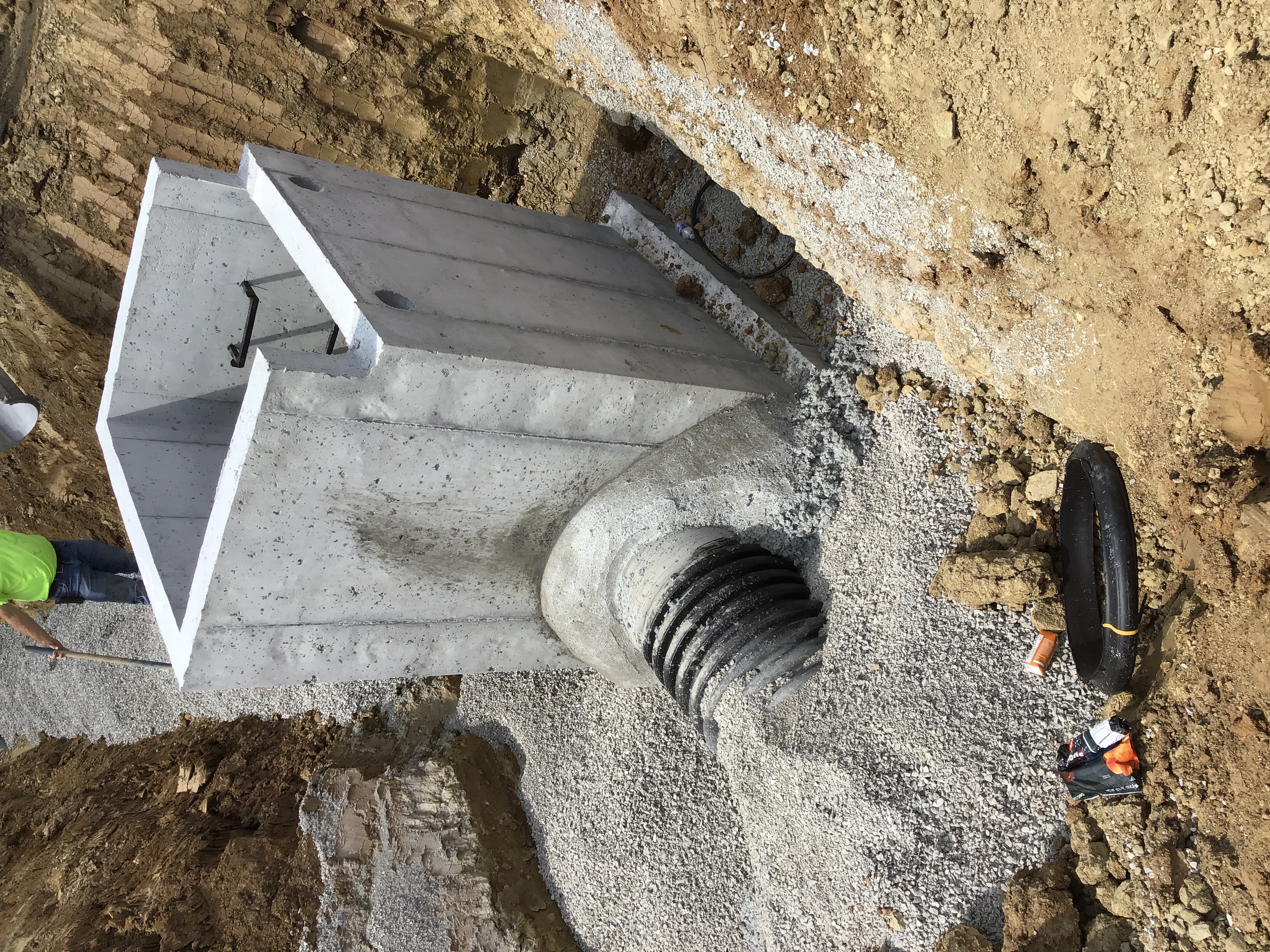

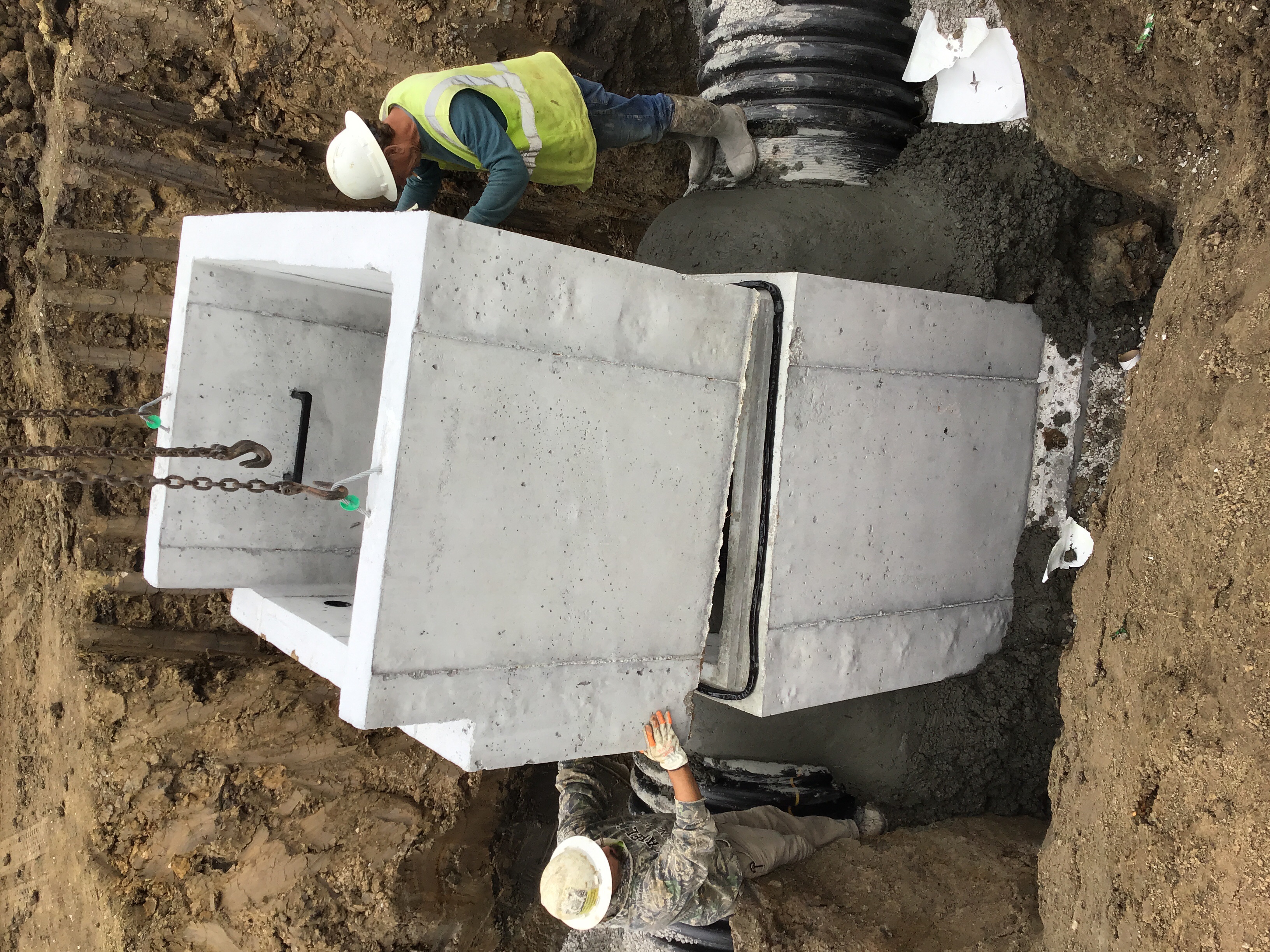

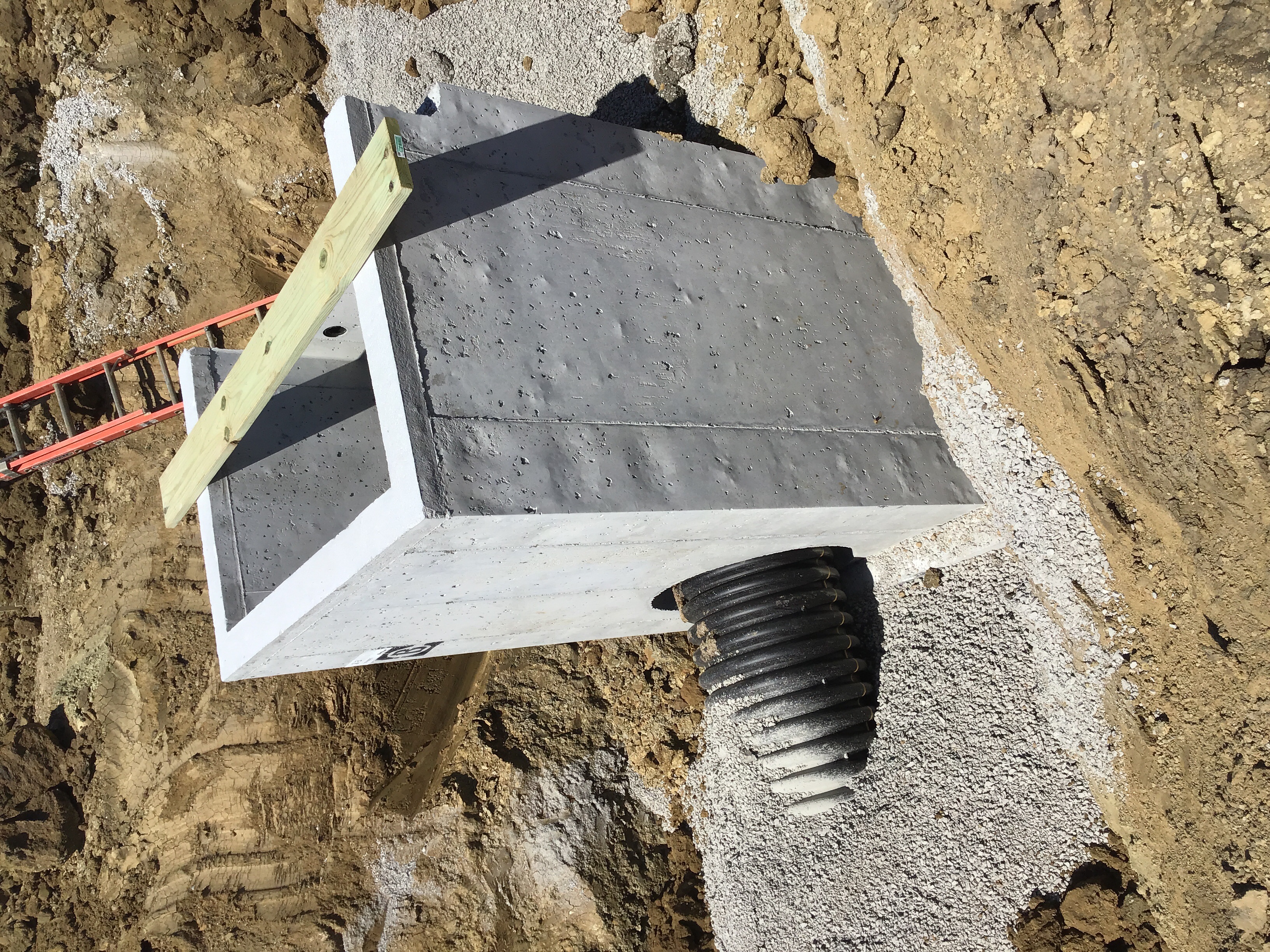

The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Informational
05/21/2020

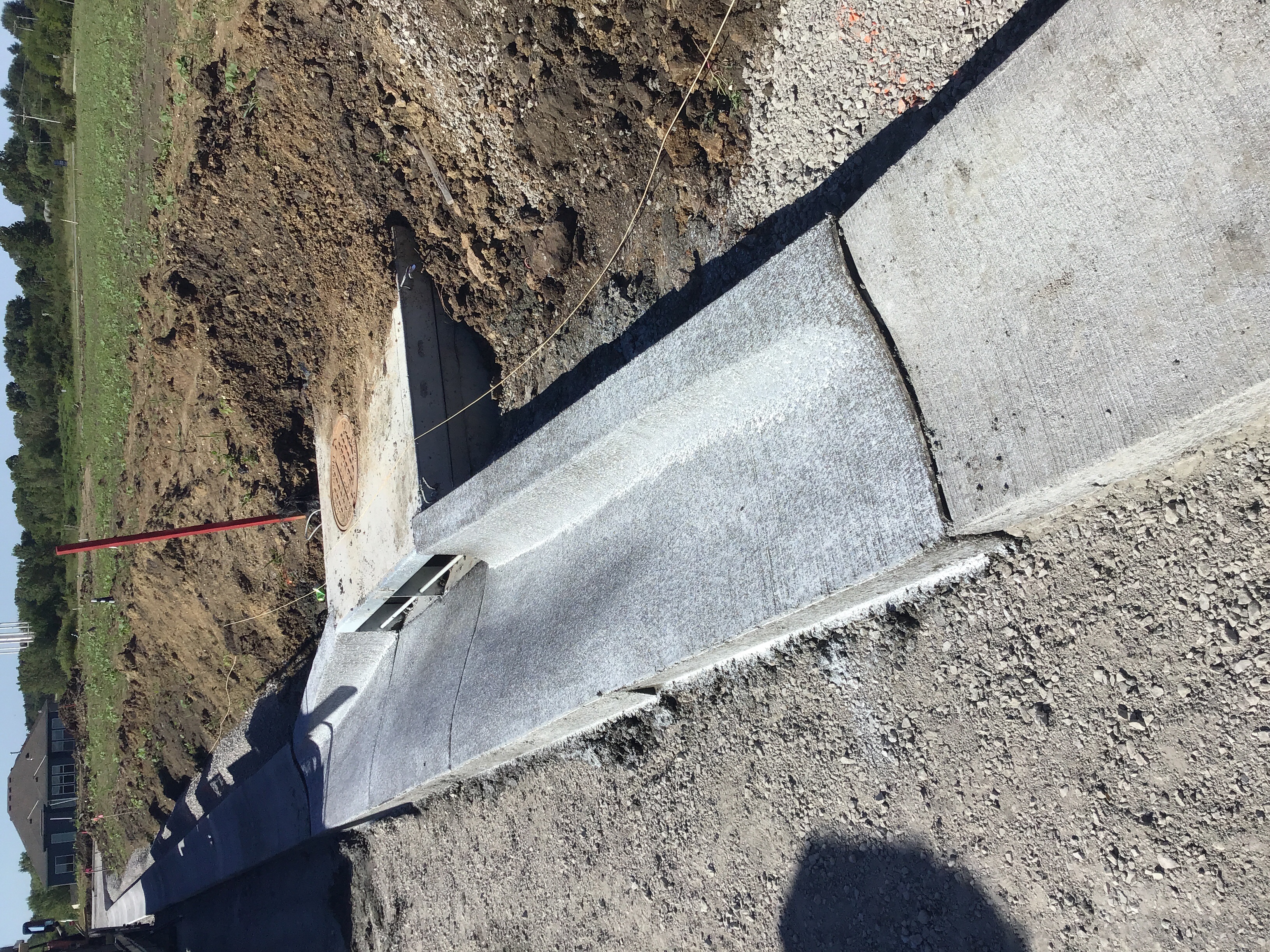

The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Storm Sewer Construction Inspection Partial 05/27/2020
Misc
Informational
05/21/2020

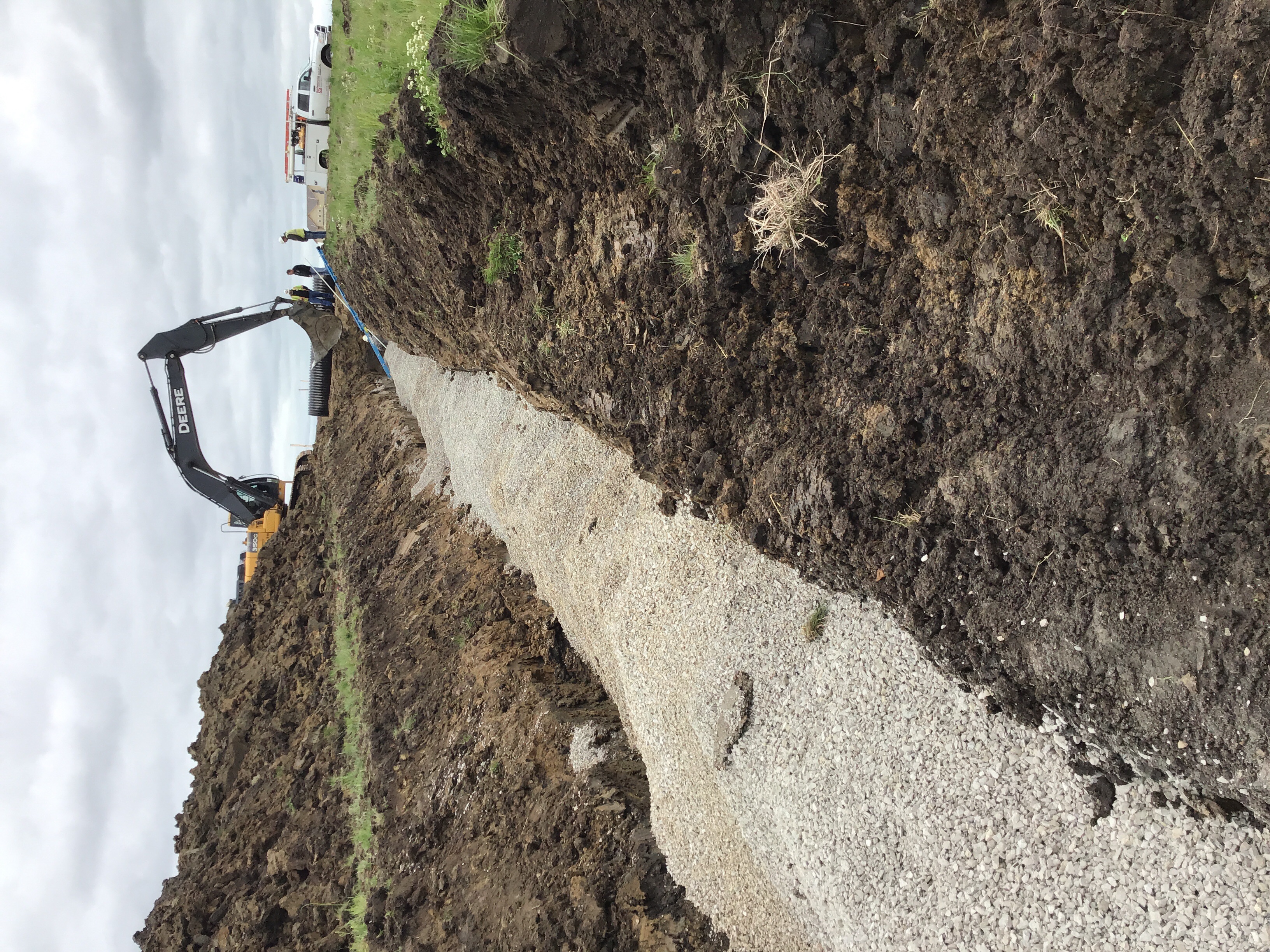

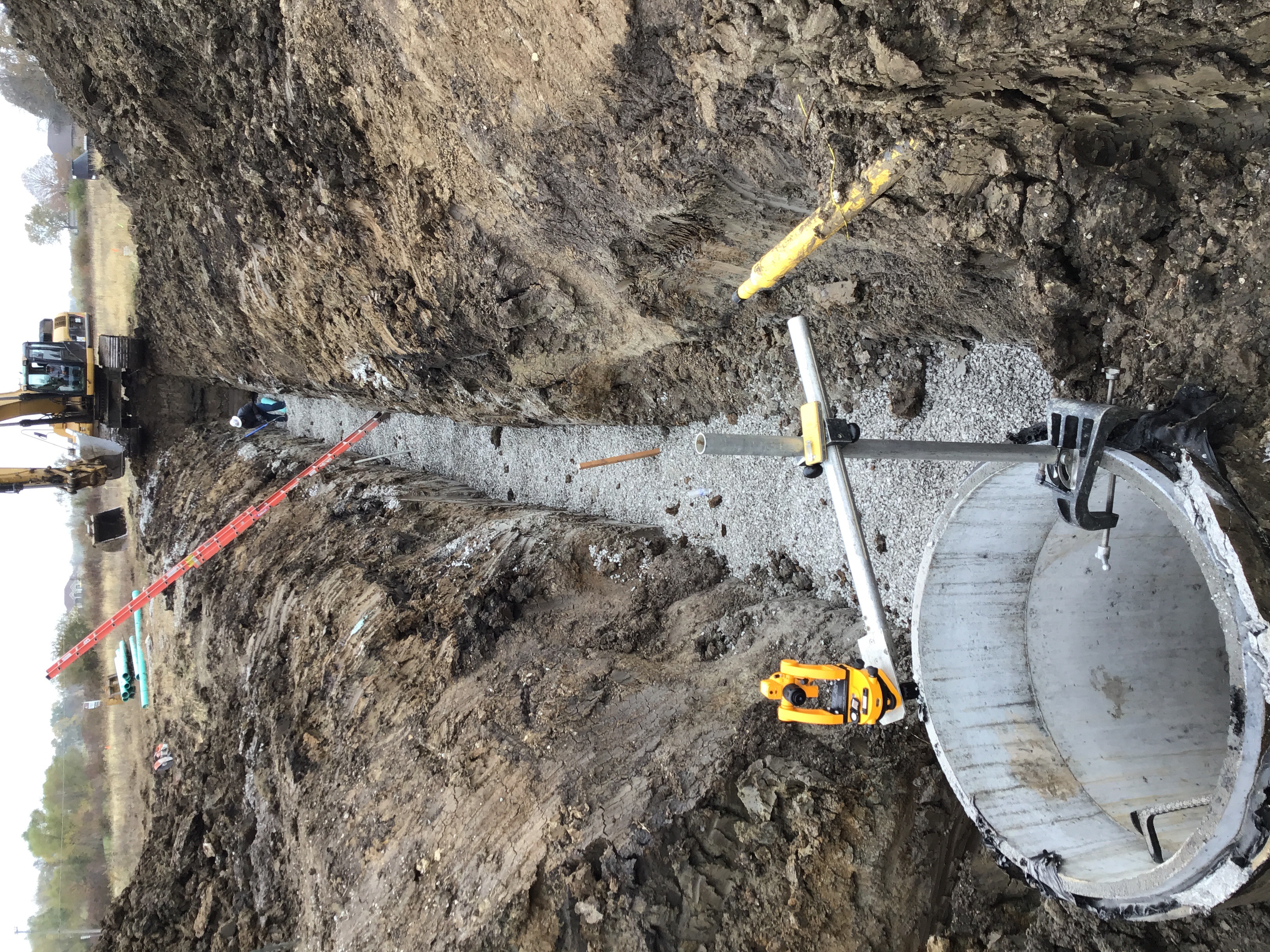

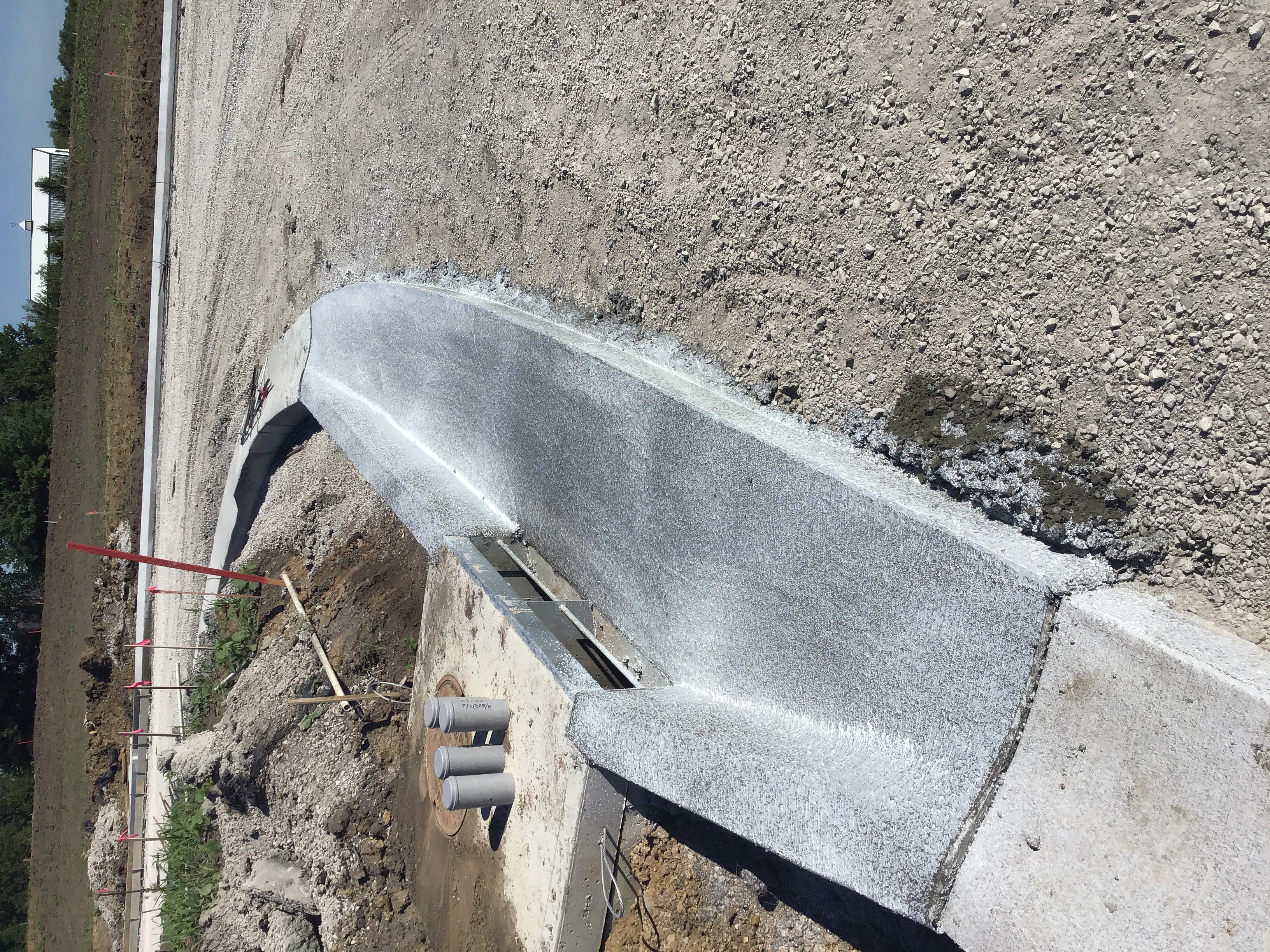

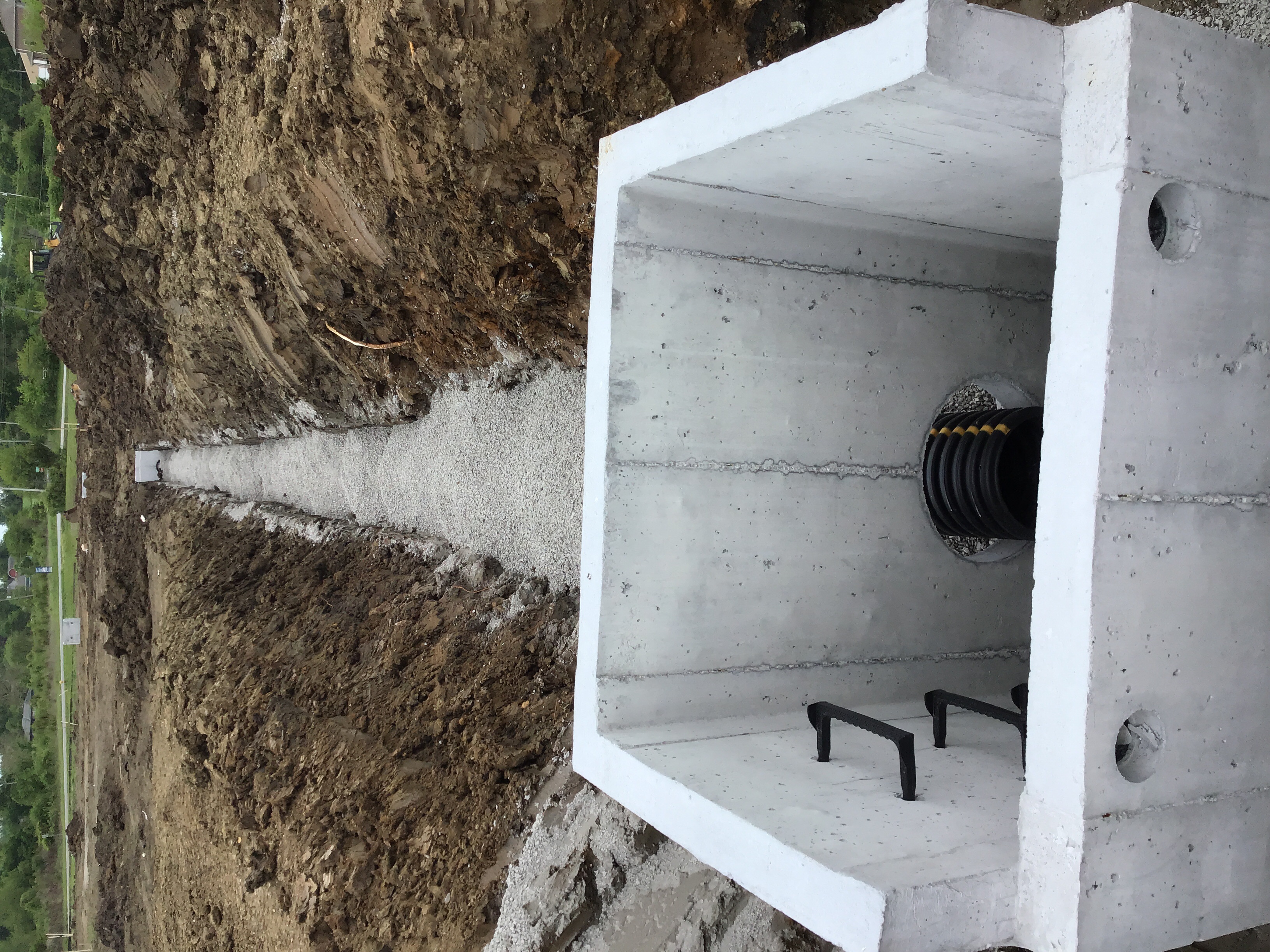

The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/21/2020

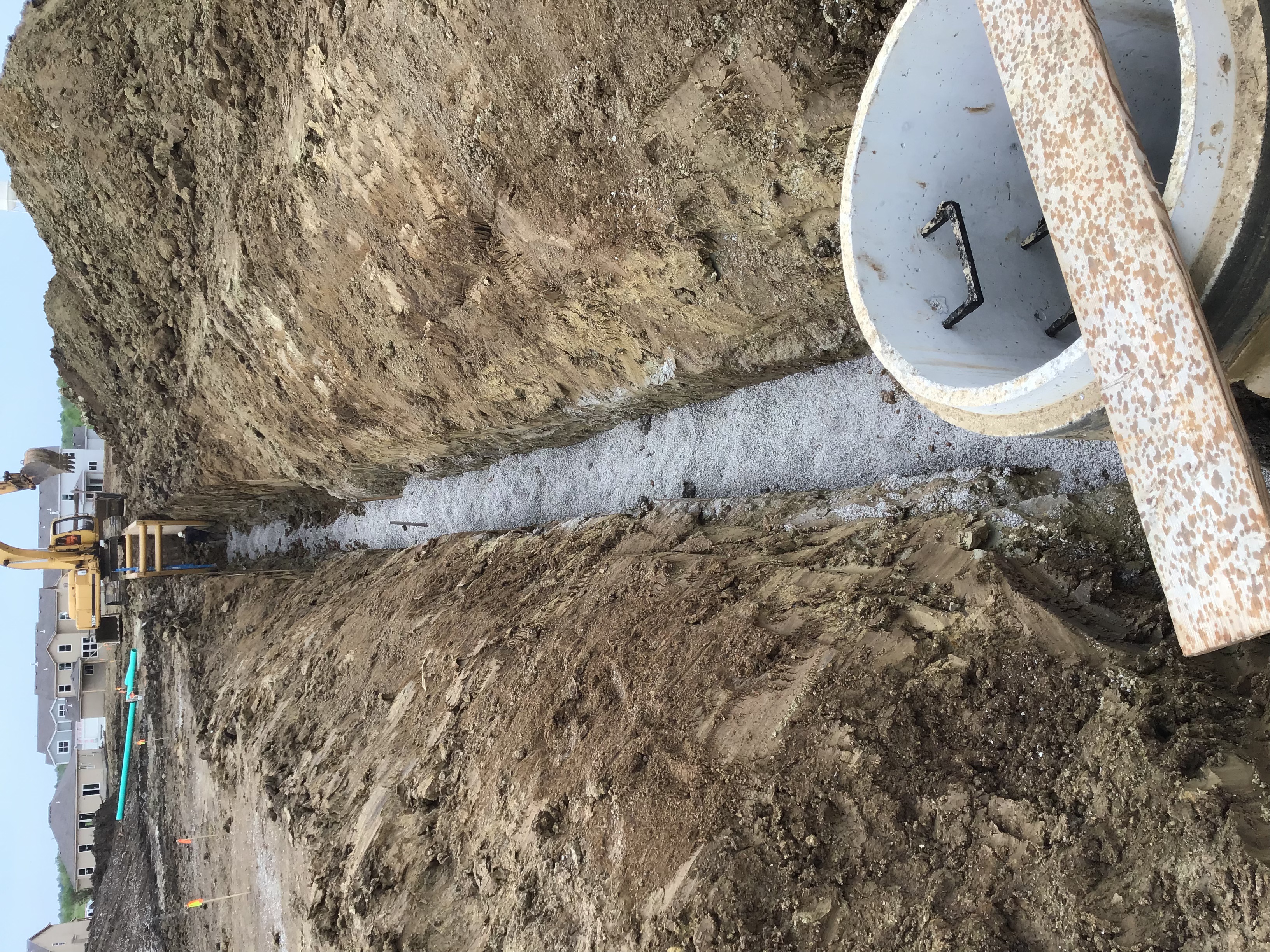

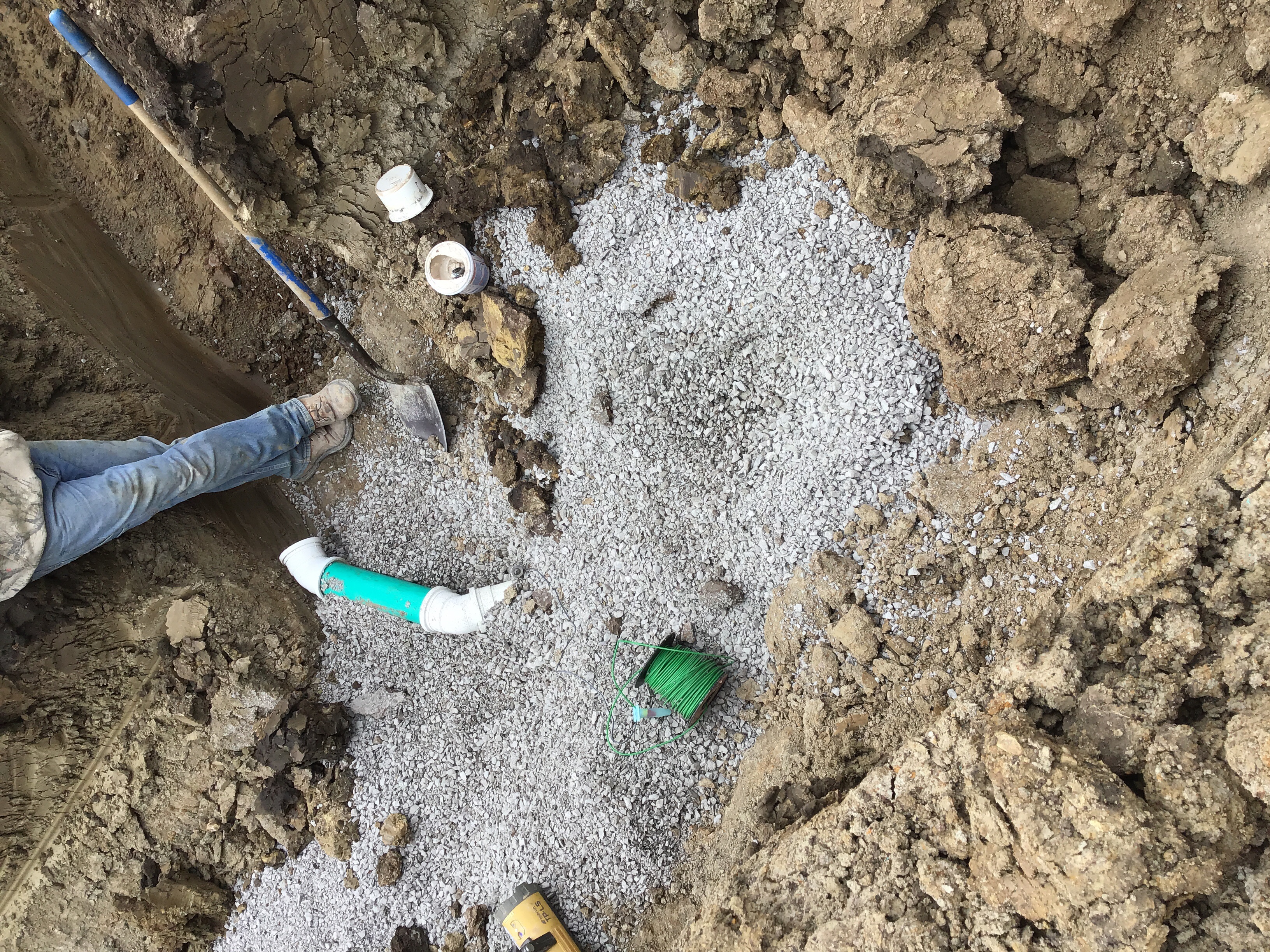

The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/21/2020

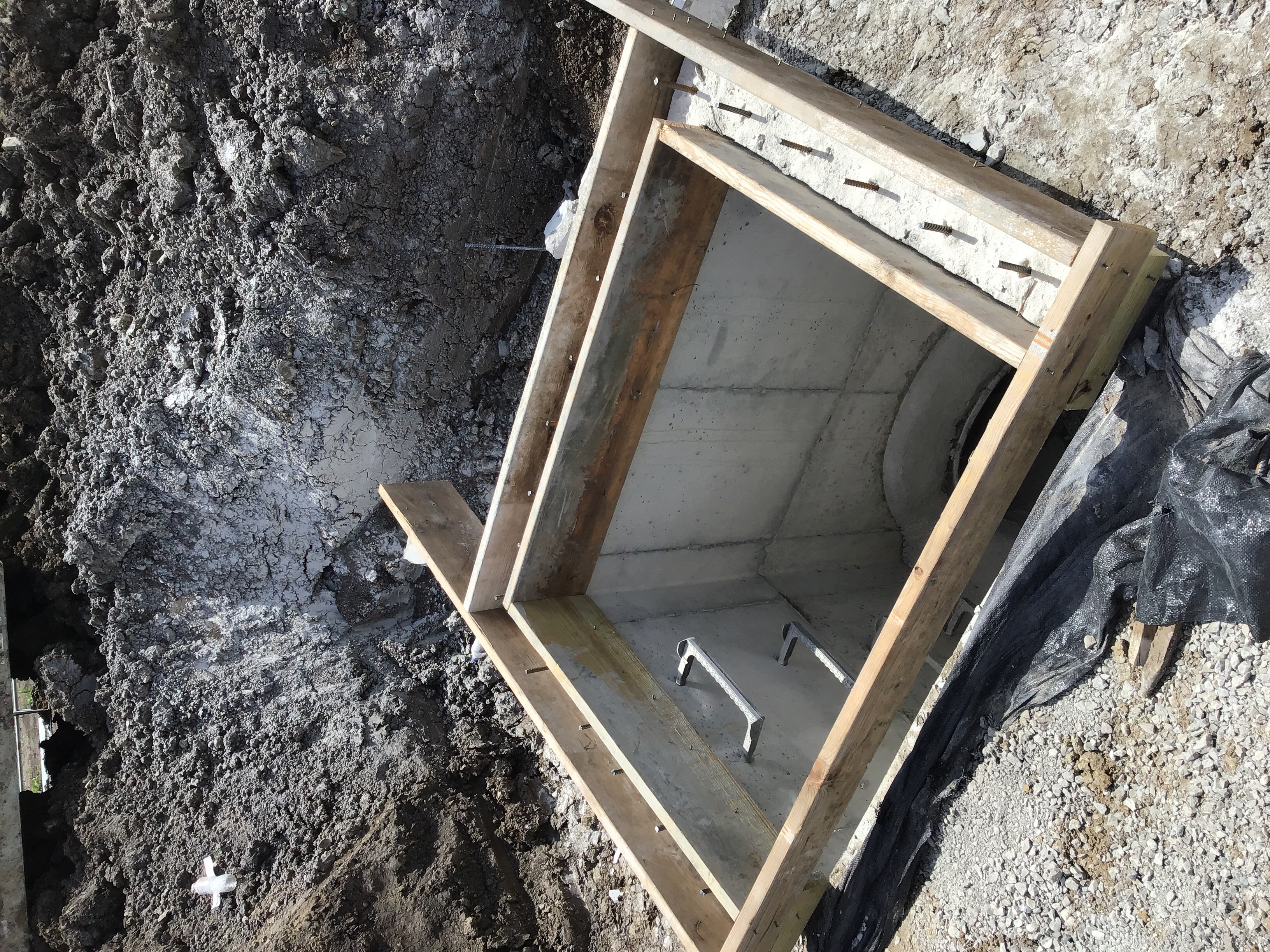

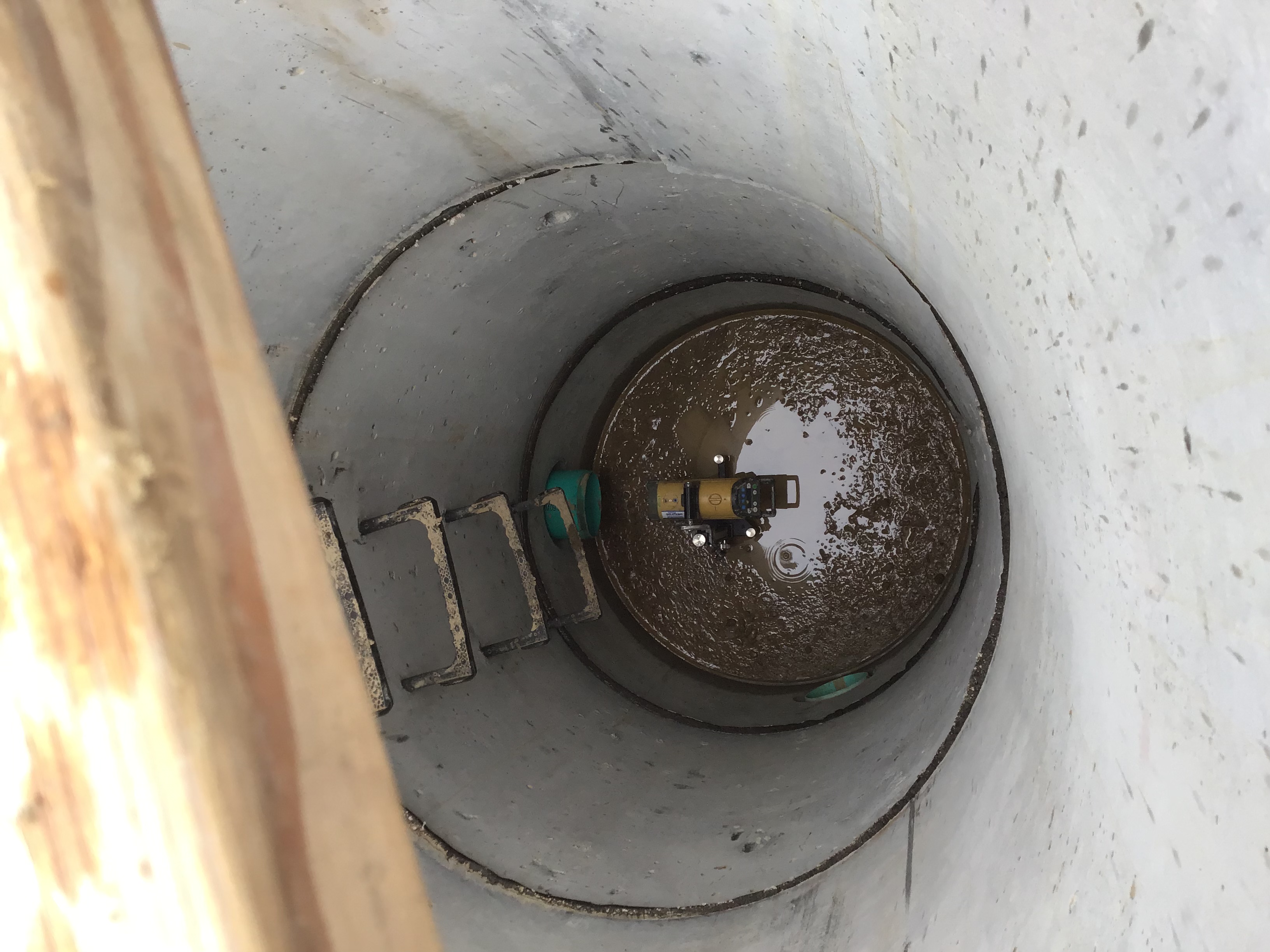

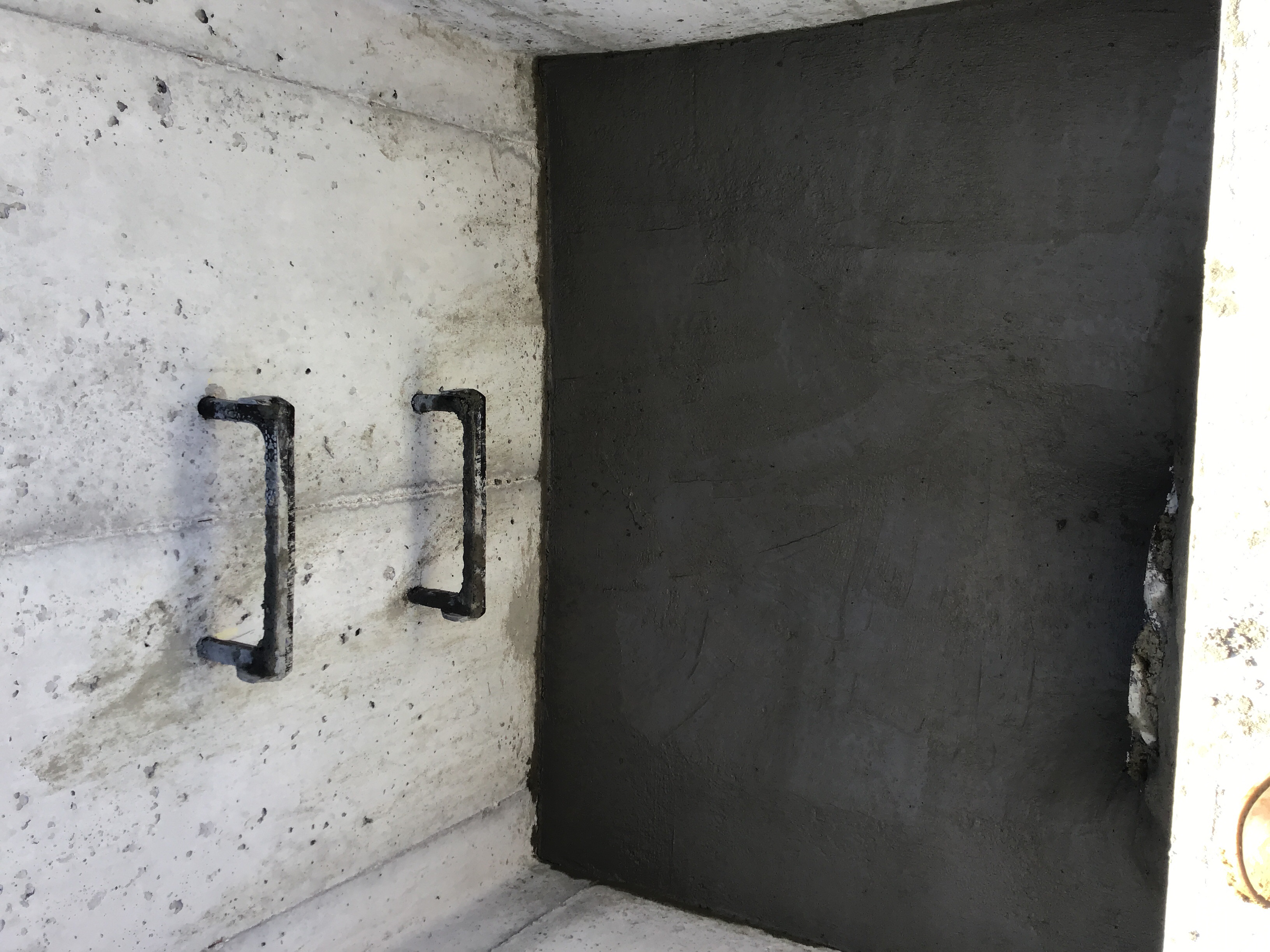

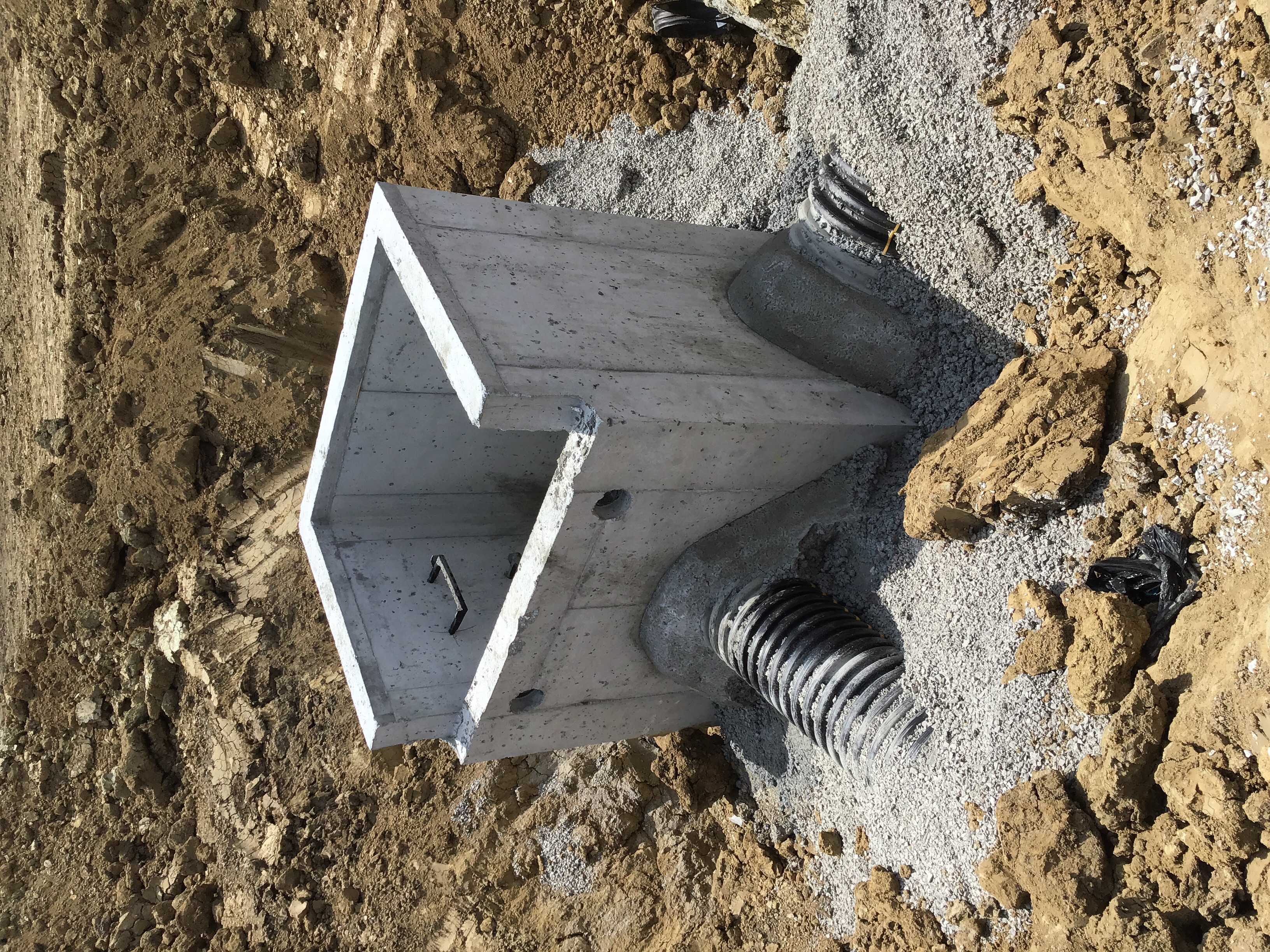

The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational

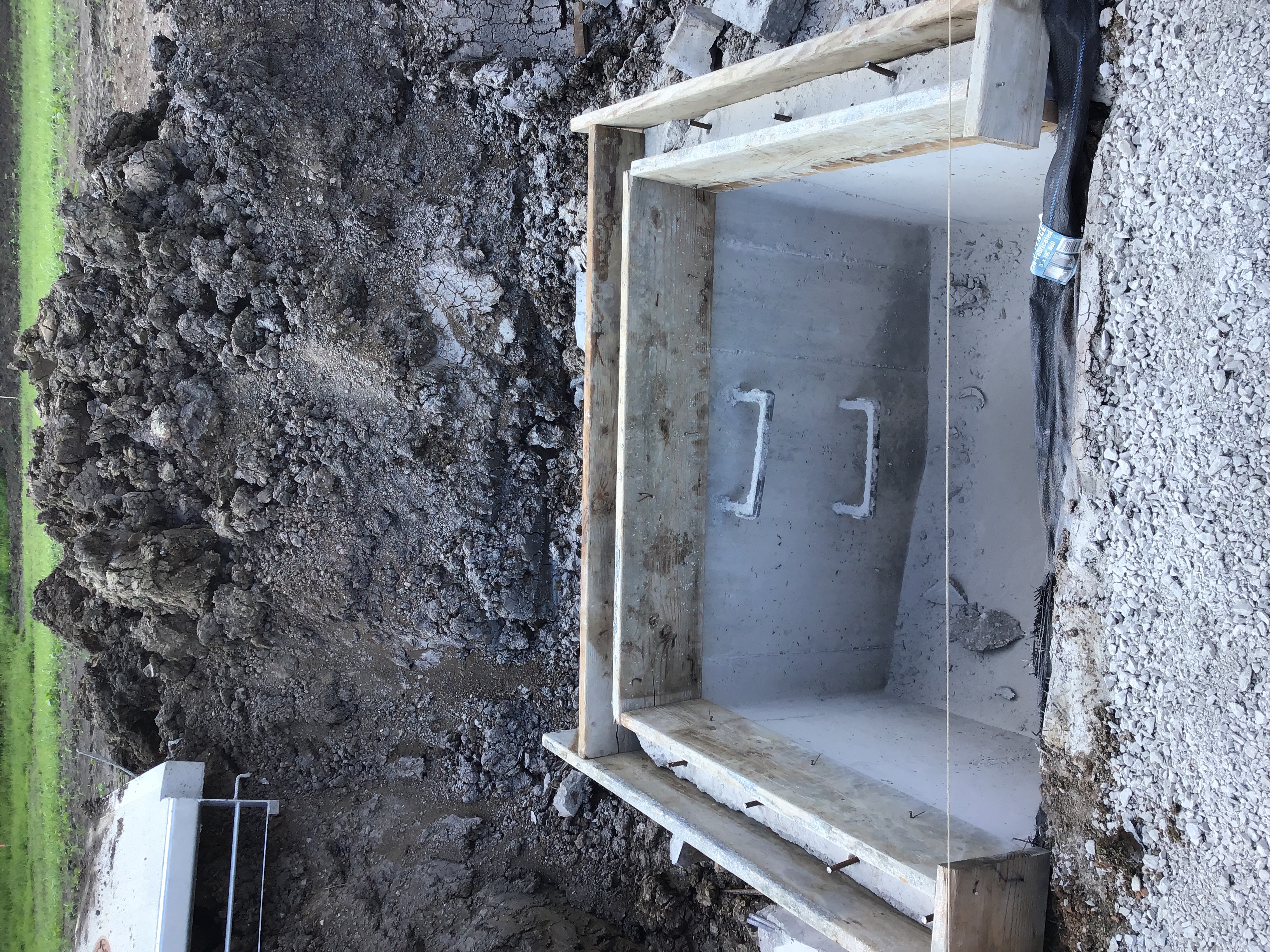

05/21/2020

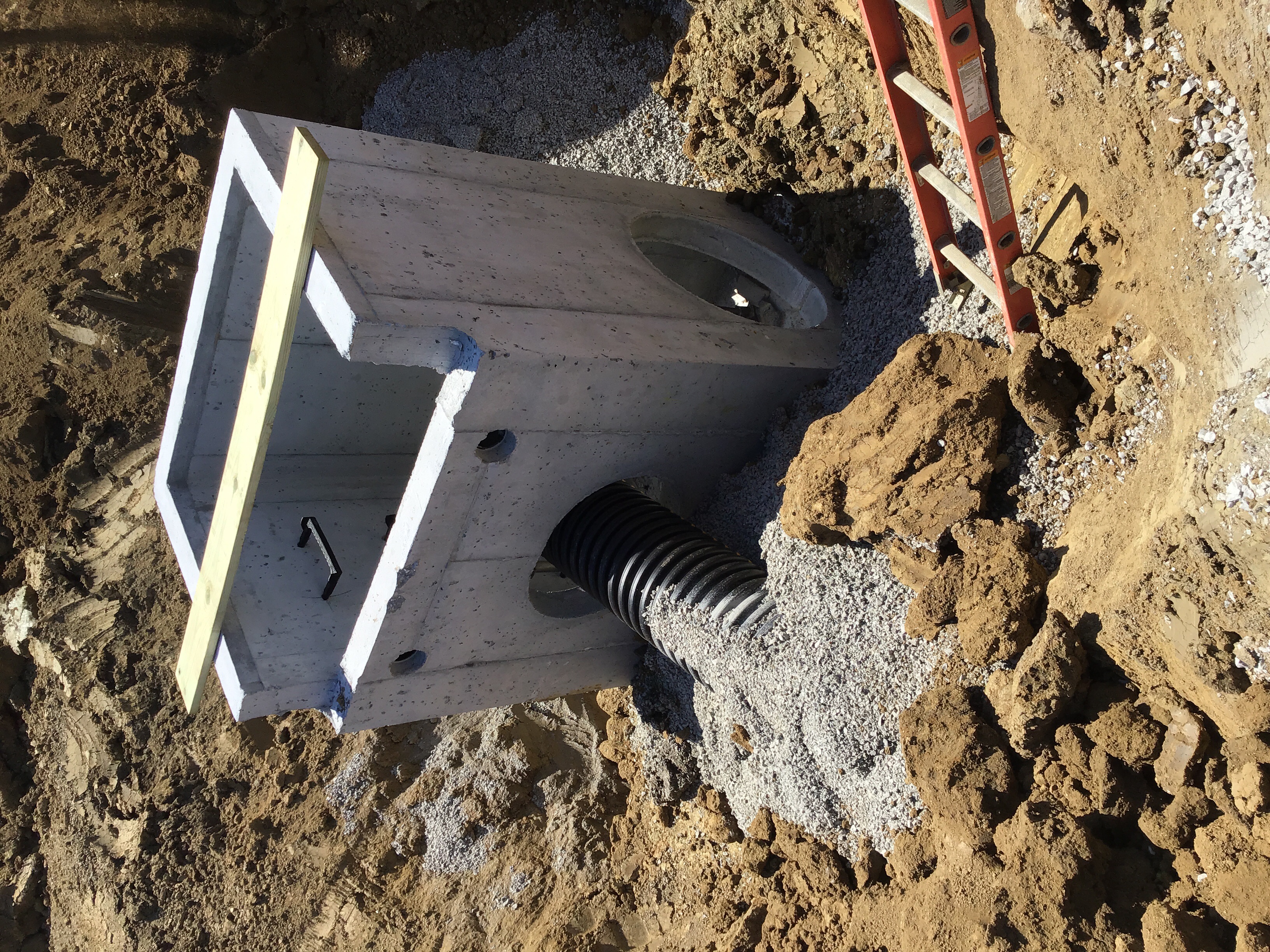

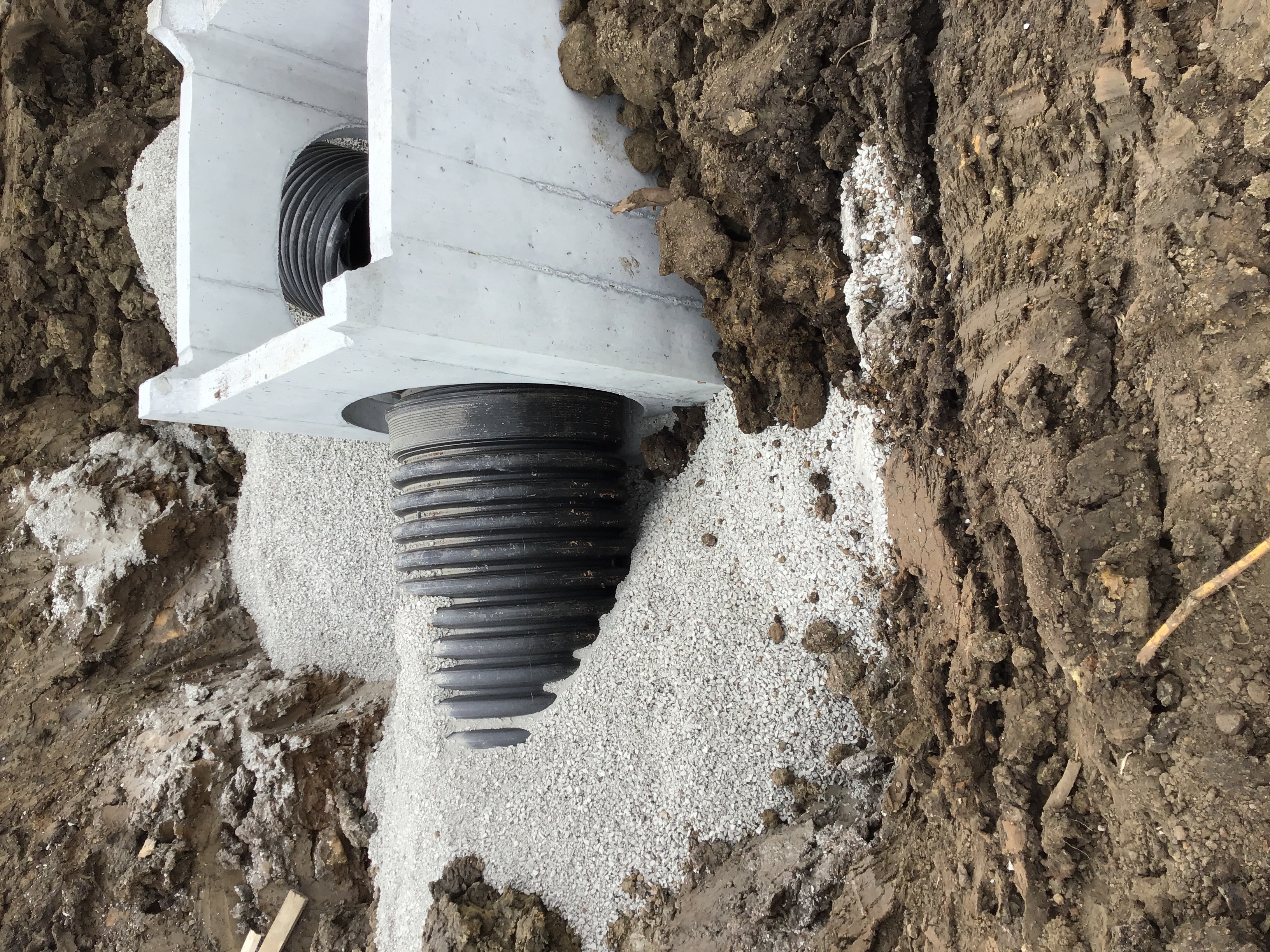

The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/21/2020

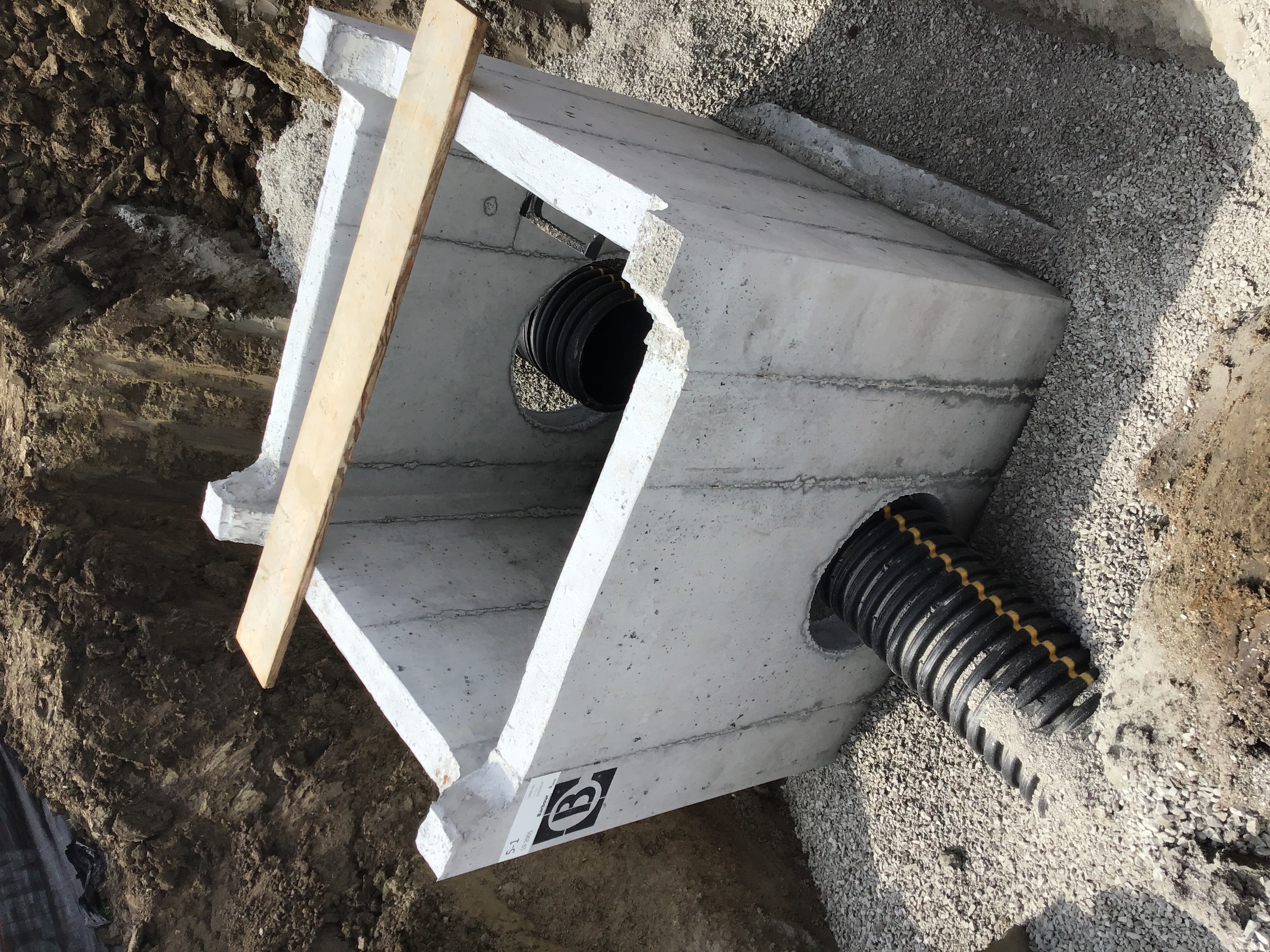

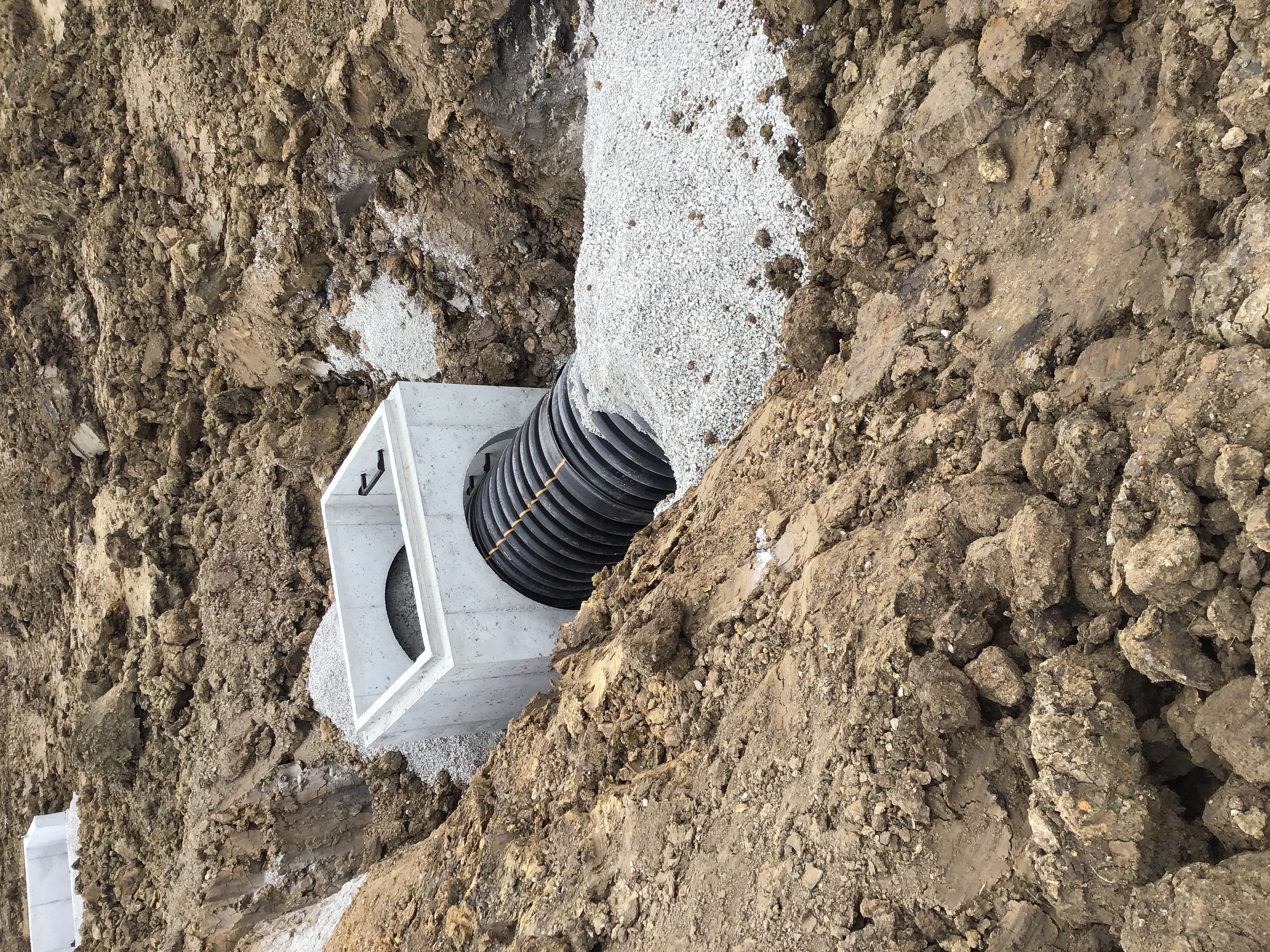

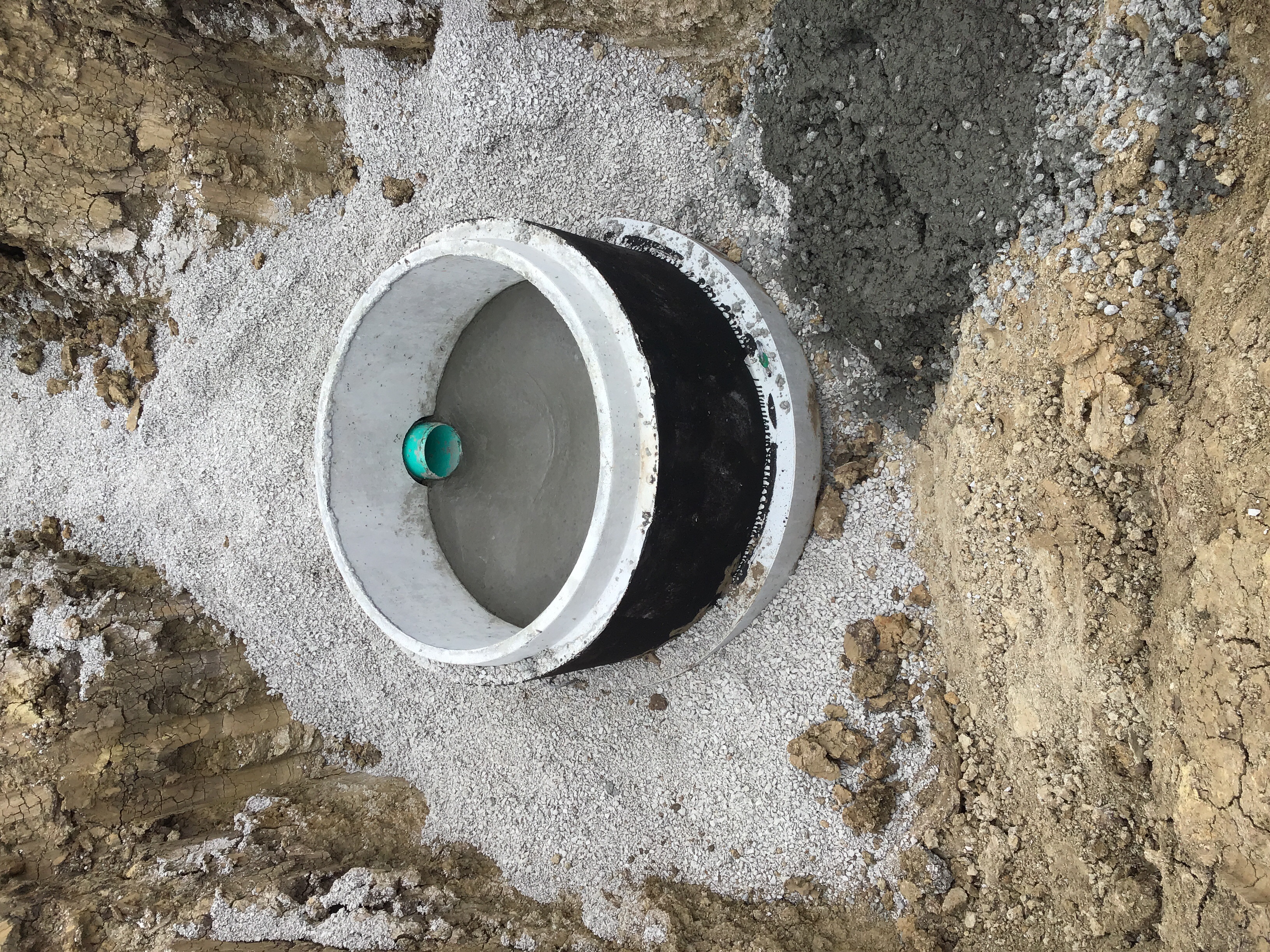

The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
05/21/2020

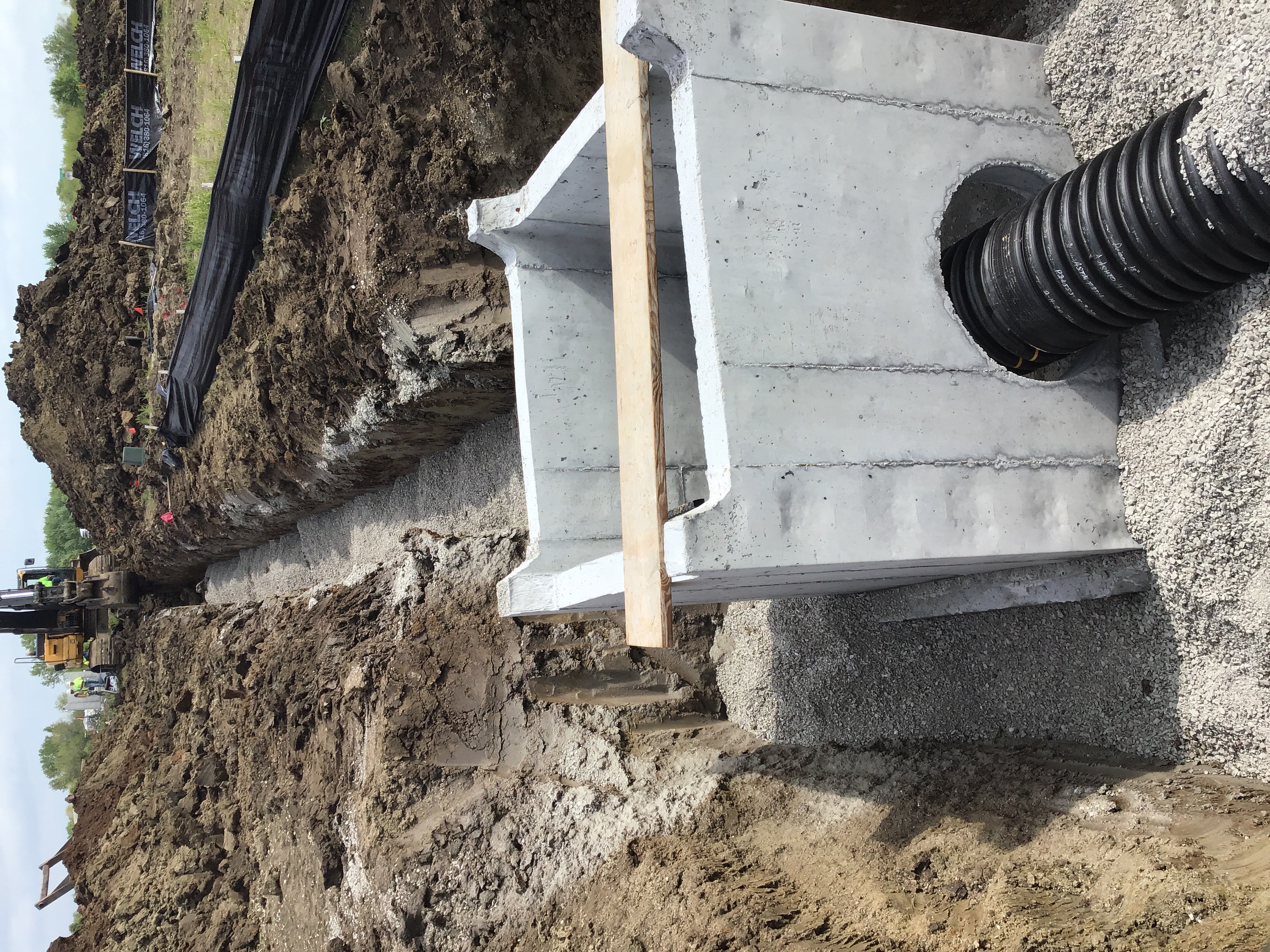

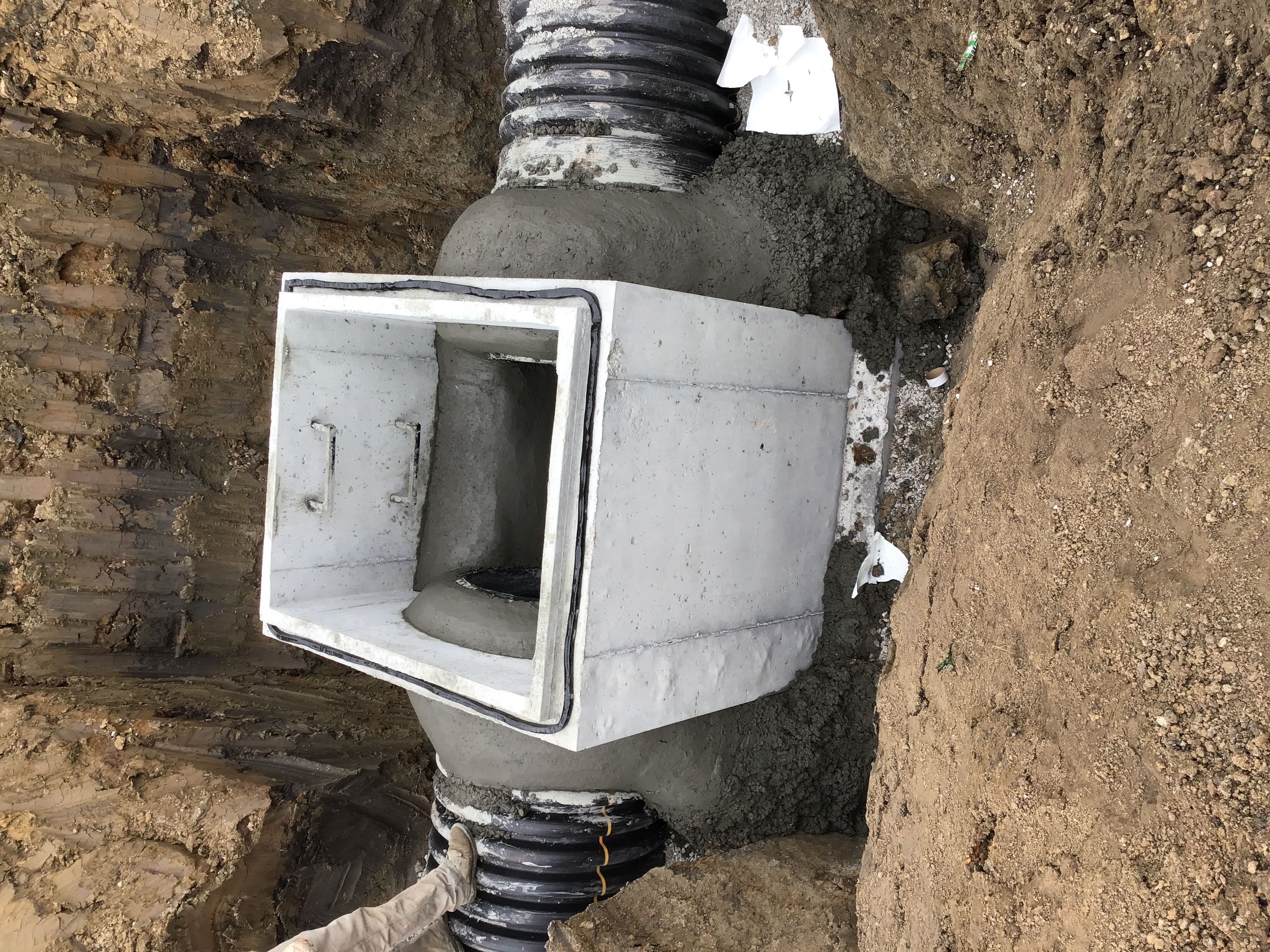

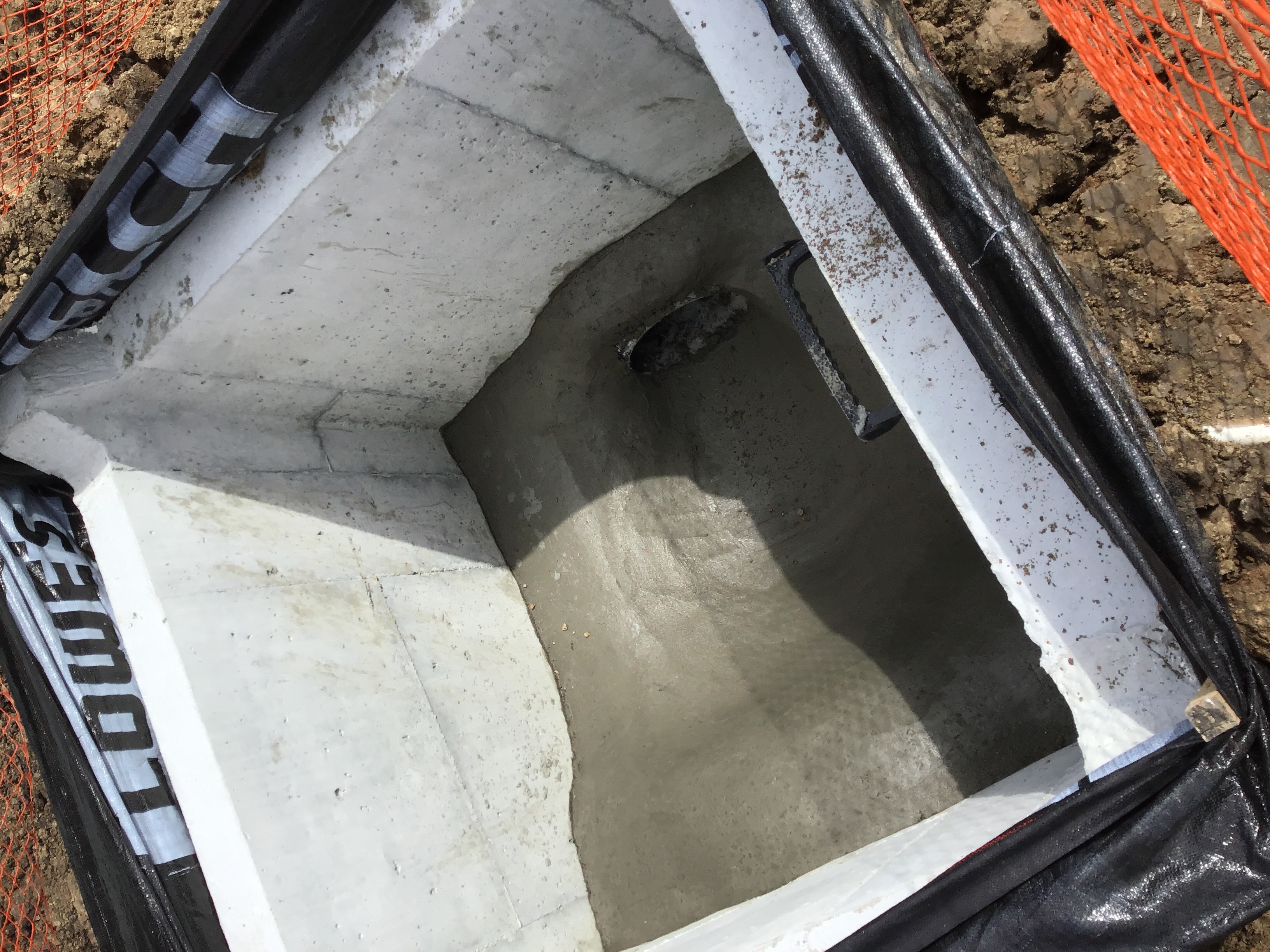

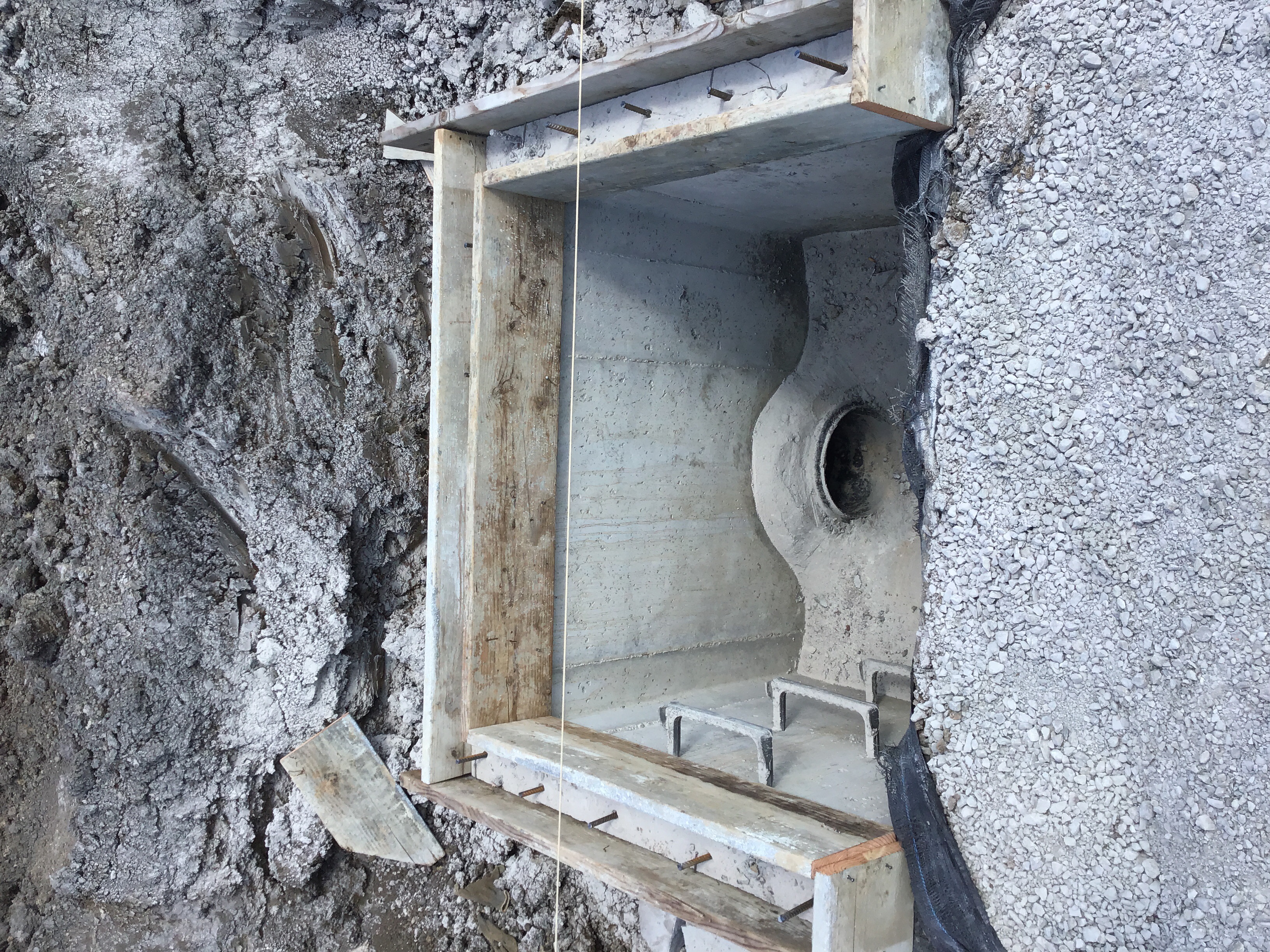

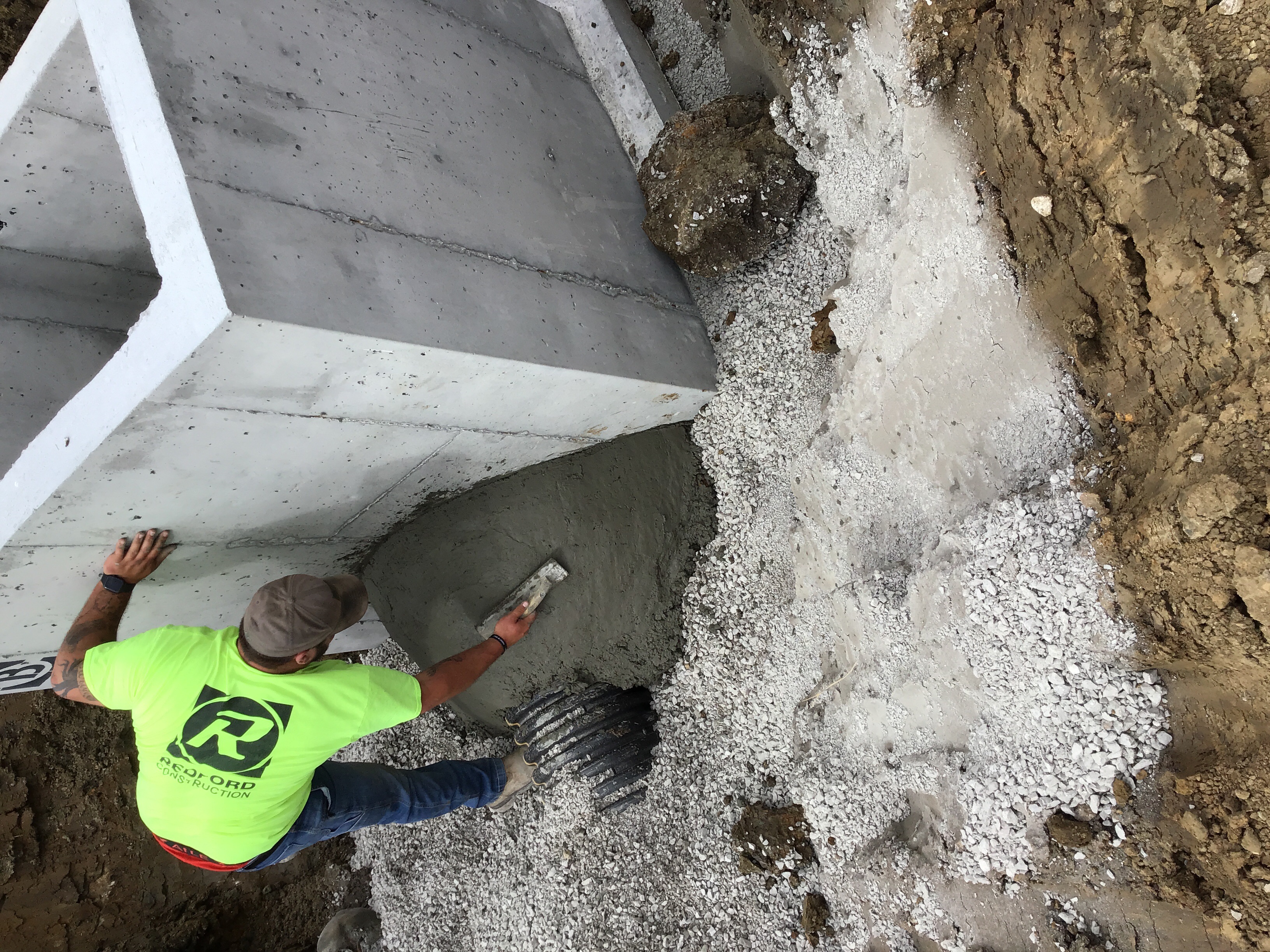

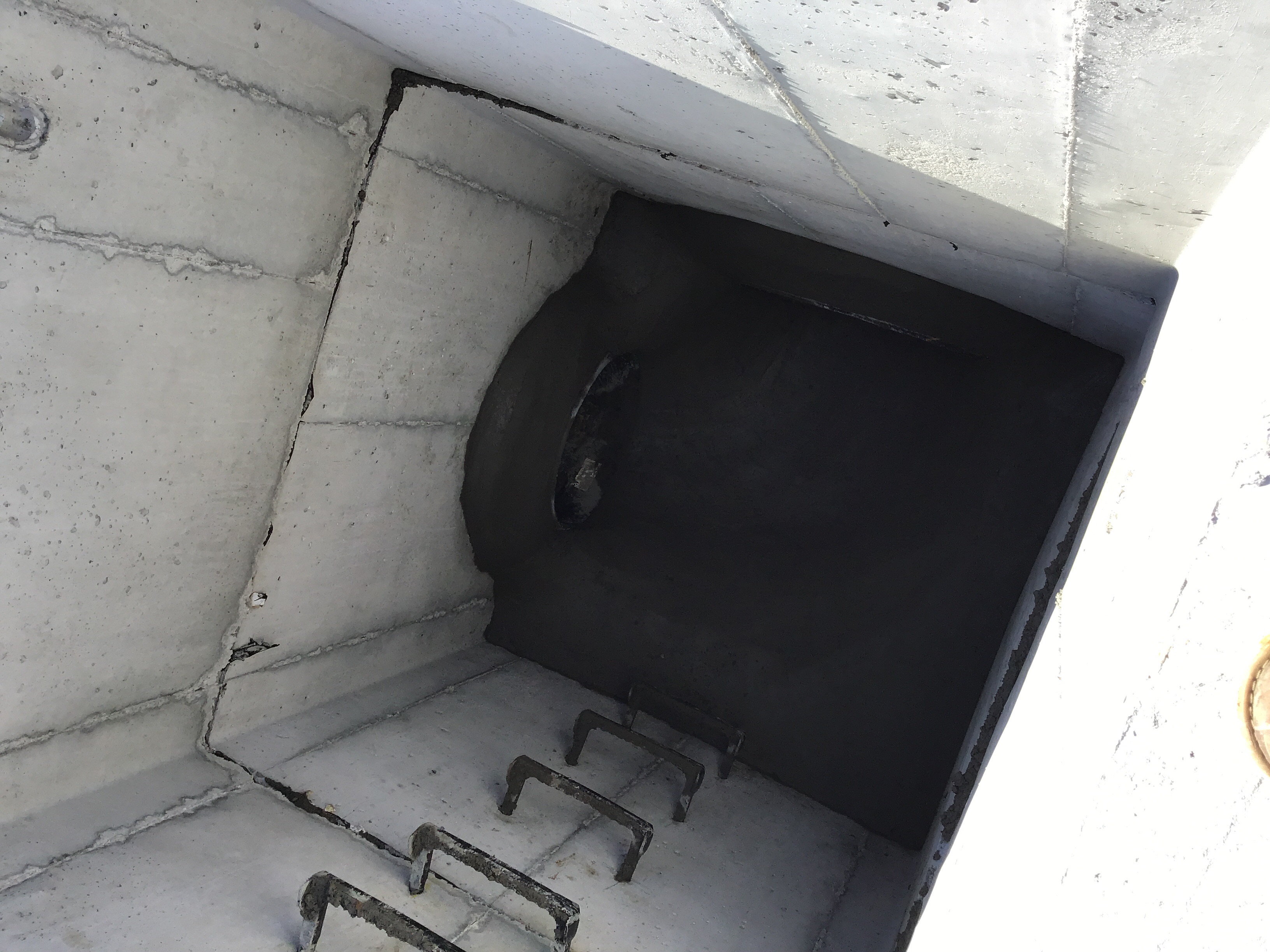

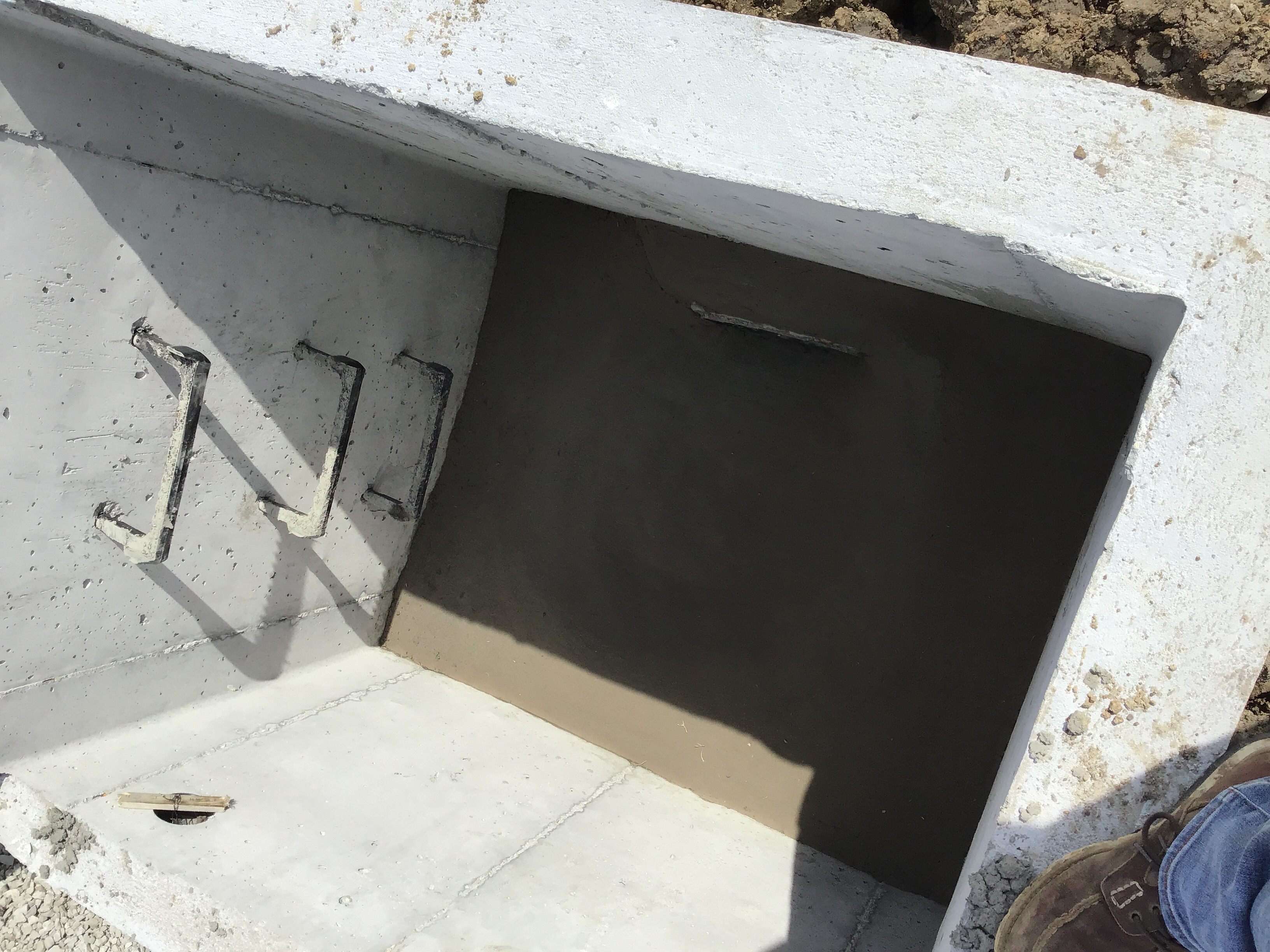

The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
05/21/2020

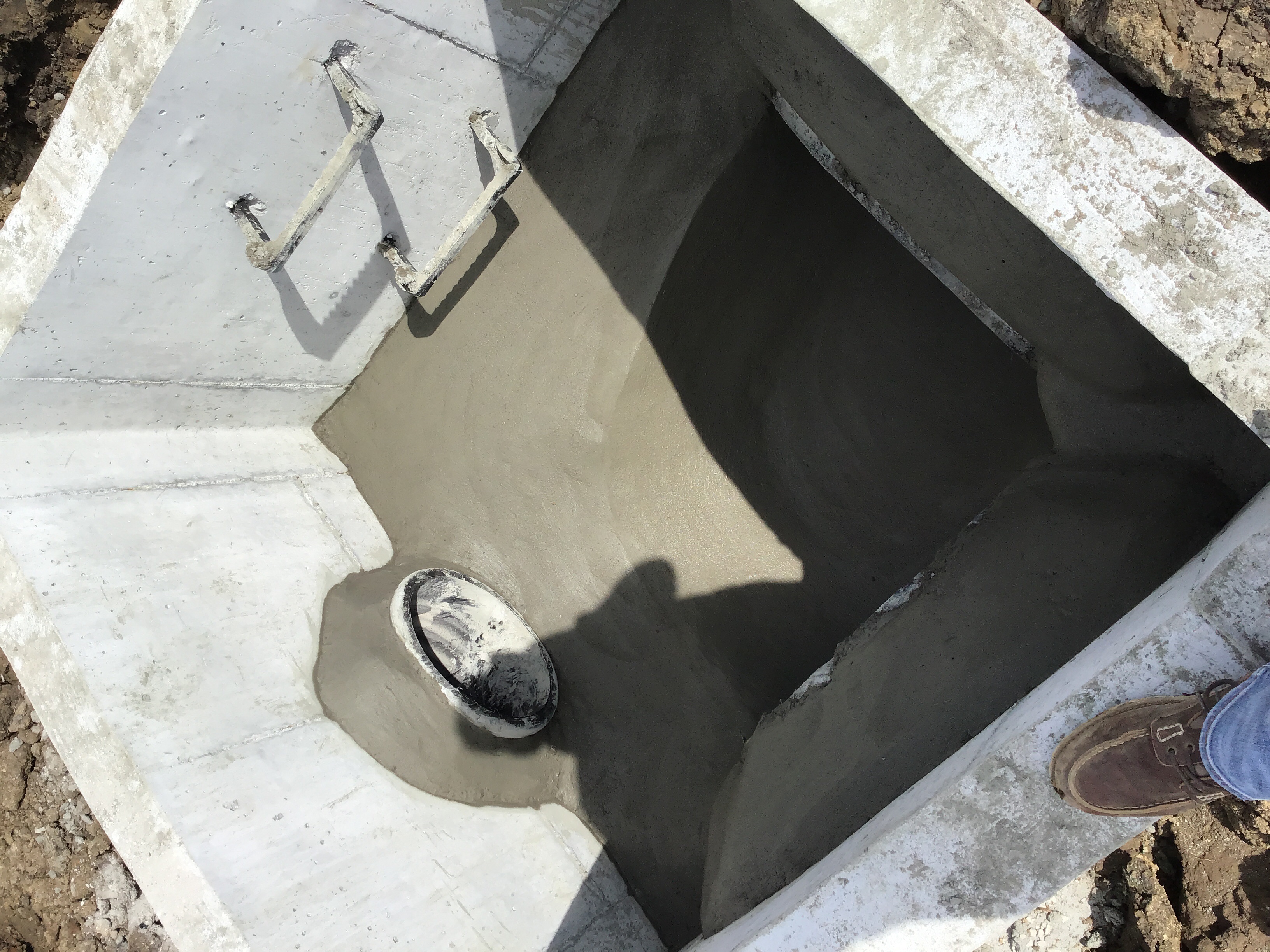

The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Informational
05/21/2020

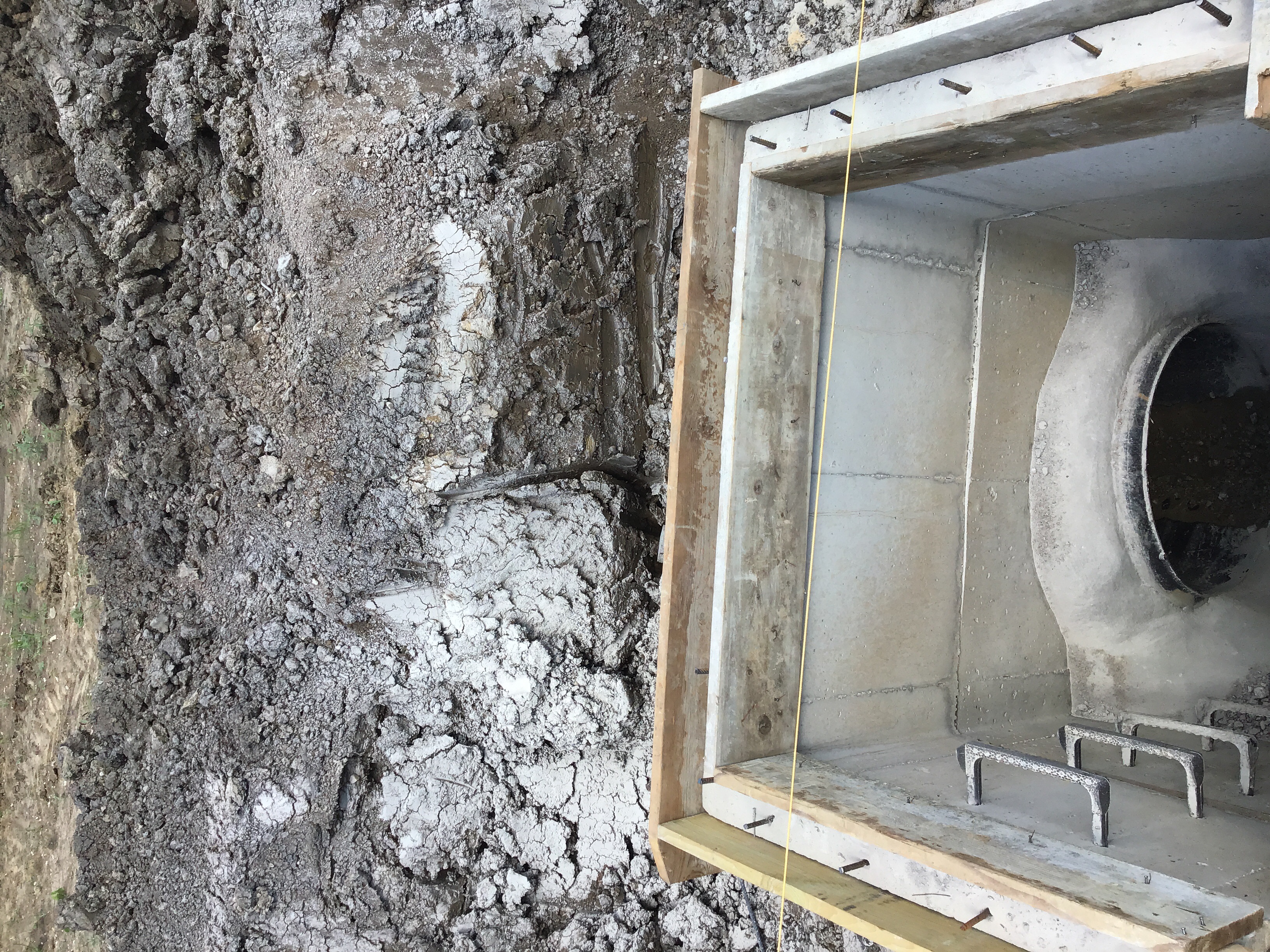

The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Misc
Informational
05/27/2020
The Redford crew continued the storm line 2 install. Photos of the work have been uploaded.
Erosion Control Inspection Failed 05/28/2020
Miscellaneous Correction
Resolved
05/28/2020
FAILED EROSION CONTROL INSPECTION There are numerous areas on site where the silt fence has failed and is allowing silt and mud to leave the site. Make corrections to the erosion control devices asap to control the silt from leaving the site.
Misc
Corrective Action Required
05/28/2020
The construction entrances for both The Manor & Reserve at Stoney creek need to be re-established. Silt and mud is running off site and into the storm water collection system. Make corrections asap.
Storm Sewer Construction Inspection Partial 06/01/2020
Misc
Informational
05/27/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
05/27/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
05/27/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
05/27/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
05/27/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
05/27/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
05/27/2020
The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Informational
05/27/2020
The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Misc
Informational
05/27/2020
The Redford crew continued the storm line 2 install. Photos of the work have been uploaded.
Misc
Informational
06/01/2020
The Redford Crew installed storm line 2 from FI 2-2 to CI 2-3 & storm line 4 from CI 2-3 to CI 4-1. The crew plans to complete the storm sewer install tomorrow and pour the remaining collars and inverts tomorrow. Photos of the work have been uploaded.
Storm Sewer Construction Inspection Partial 6/2/2020 6/2/2020 06/02/2020
Misc
Informational
06/01/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
06/01/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
06/01/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
06/01/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
06/01/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
06/01/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
06/01/2020
The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Informational
06/01/2020
The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Misc
Informational
06/01/2020
The Redford crew continued the storm line 2 install. Photos of the work have been uploaded.
Misc
Informational
06/01/2020
The Redford Crew installed storm line 2 from FI 2-2 to CI 2-3 & storm line 4 from CI 2-3 to CI 4-1. The crew plans to complete the storm sewer install tomorrow and pour the remaining collars and inverts tomorrow. Photos of the work have been uploaded.
Misc
Informational
06/02/2020

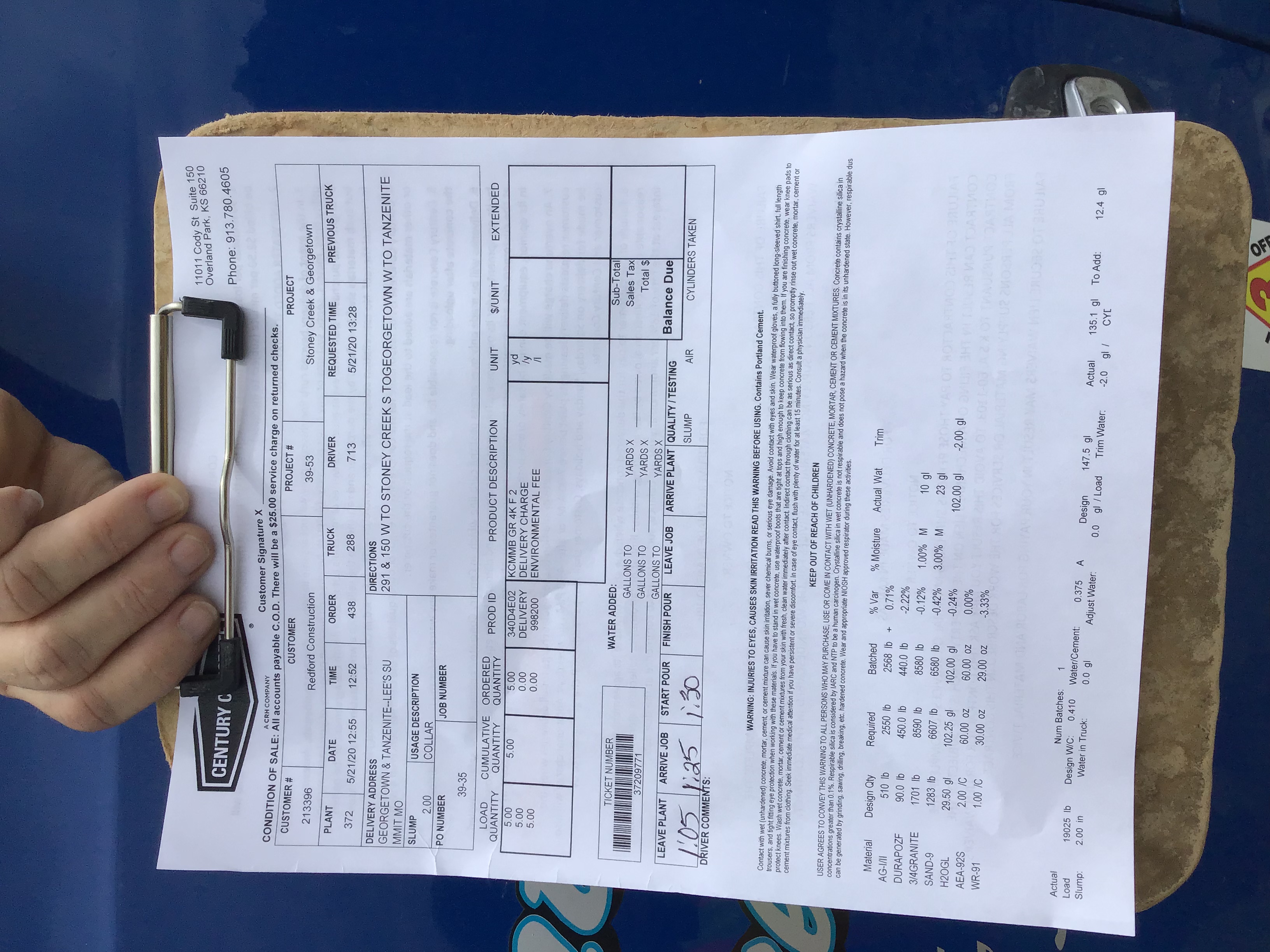

The Redford crew poured the storm inverts for inlets 2-1, 2-2, 2-3 & 4-1 this morning. Photos of the work are uploaded. The crew plans to finish up the storm line 2 run today. I will return for further inspection today.
Storm Sewer Construction Inspection Partial 6/2/2020 6/2/2020 06/03/2020
Misc
Informational
06/02/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Informational
06/02/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Informational
06/02/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Informational
06/02/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Informational
06/02/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Informational
06/02/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Informational
06/02/2020
The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Informational
06/02/2020
The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Misc
Informational
06/02/2020
The Redford crew continued the storm line 2 install. Photos of the work have been uploaded.
Misc
Informational
06/02/2020
The Redford Crew installed storm line 2 from FI 2-2 to CI 2-3 & storm line 4 from CI 2-3 to CI 4-1. The crew plans to complete the storm sewer install tomorrow and pour the remaining collars and inverts tomorrow. Photos of the work have been uploaded.
Misc
Informational
06/02/2020
The Redford crew poured the storm inverts for inlets 2-1, 2-2, 2-3 & 4-1 this morning. Photos of the work are uploaded. The crew plans to finish up the storm line 2 run today. I will return for further inspection today.
Misc
Informational
06/03/2020
The Redford crew completed the storm sewer install for The Manor. The crew set storm box 2-4 and installed the remainder of storm line 2 from 2-3 to 2-4. Inverts & collars have been poured and the lids are set. The crew is moving over to The Reserve side. Photos of the work have been uploaded.
Sanitary Sewer - Air Test Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 2:30 PM I observed the sanitary sewer air test for the project. Results are as follows. Sanitary Line A segment between MH C-4 & A-1 Line held at 4psi for 7:34 with no drop Test Passed Line A segment between MH A-1 & A-2 Line held at 4psi for 9:02 with no drop Test Passed Line B segment between existing MH A-11 & B-1 Line held at 4psi for 7:34 with no drop Test Passed Line B segment between B-1 & B-2 Line held at 4psi for 8:52 with no drop Test Passed Air testing of both sanitary sewer lines passed.
Sanitary Sewer - Mandrel Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 3:03 PM I verified that the correct mandrel was used for the test according to the City Of LS Design and Construction Manual. I observed the mandrel pull through both sanitary lines A & B with no deflection. Test Passed
Sanitary Sewer - Vacuum Passed 6/18/2020 06/18/2020
Misc
Informational
06/18/2020
John DiMauro 06/18/2020 3:07 PM I observed the vacuum test for the sanitary sewer manholes on lines A & B. The results are as follows: MH A-1 less than 10'ft deep Held at 10 on the gauge for 2 minutes with no drop Test Passed MH A-2 Less than 10'ft deep Held at 10 on the gauge for 2 minutes with no drop Test Passed MH B-1 13'ft deep Held at 10 on the gauge for 2.5 minutes with no drop. Test Passed MH B-2 Less than 10'ft deep Tested for 2 minutes with a drop from 10 to 9.5 Test Passed
Grading/Excavation/Fill Inspection Partial 07/07/2020
Misc
Informational
07/07/2020

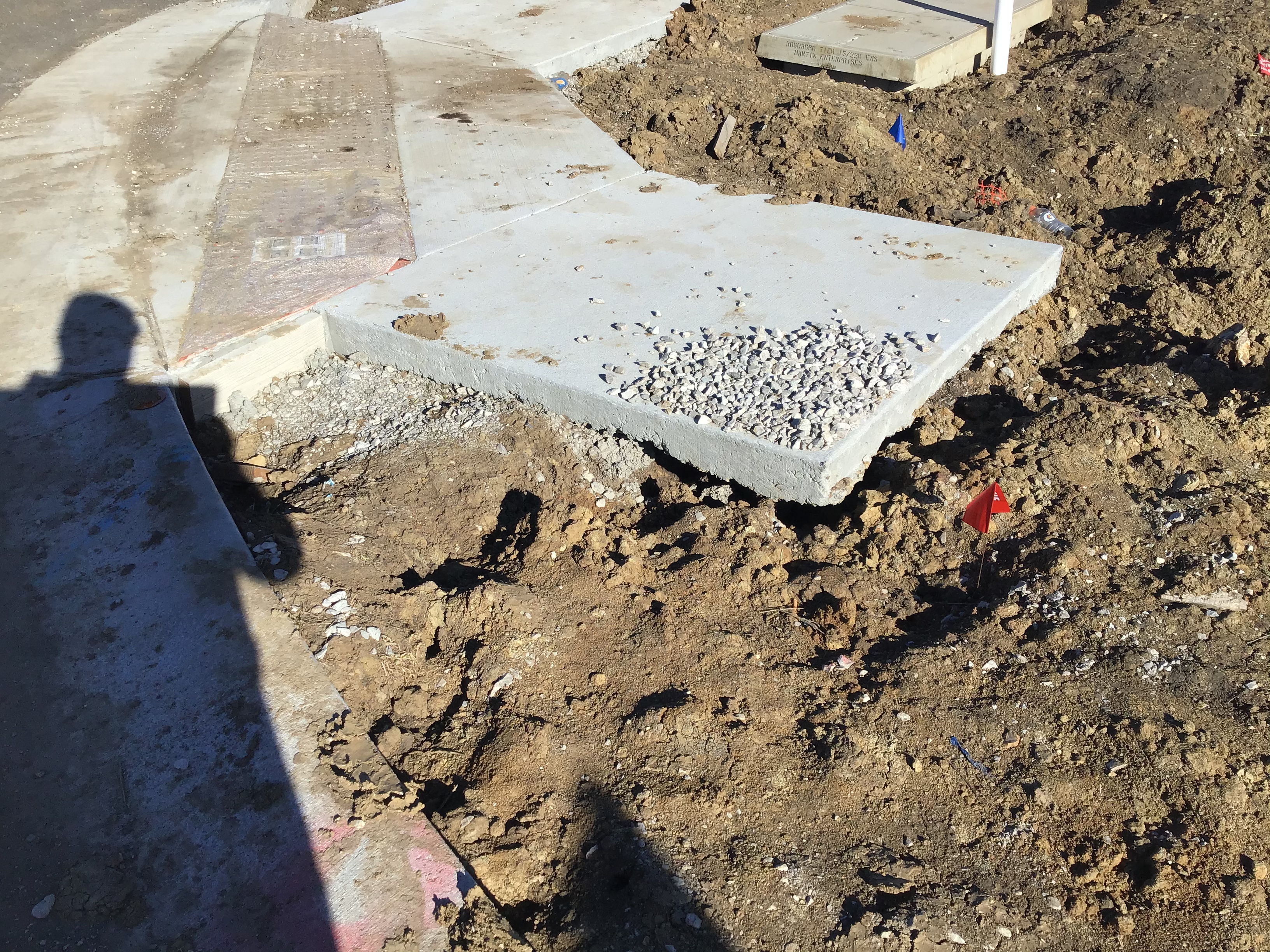

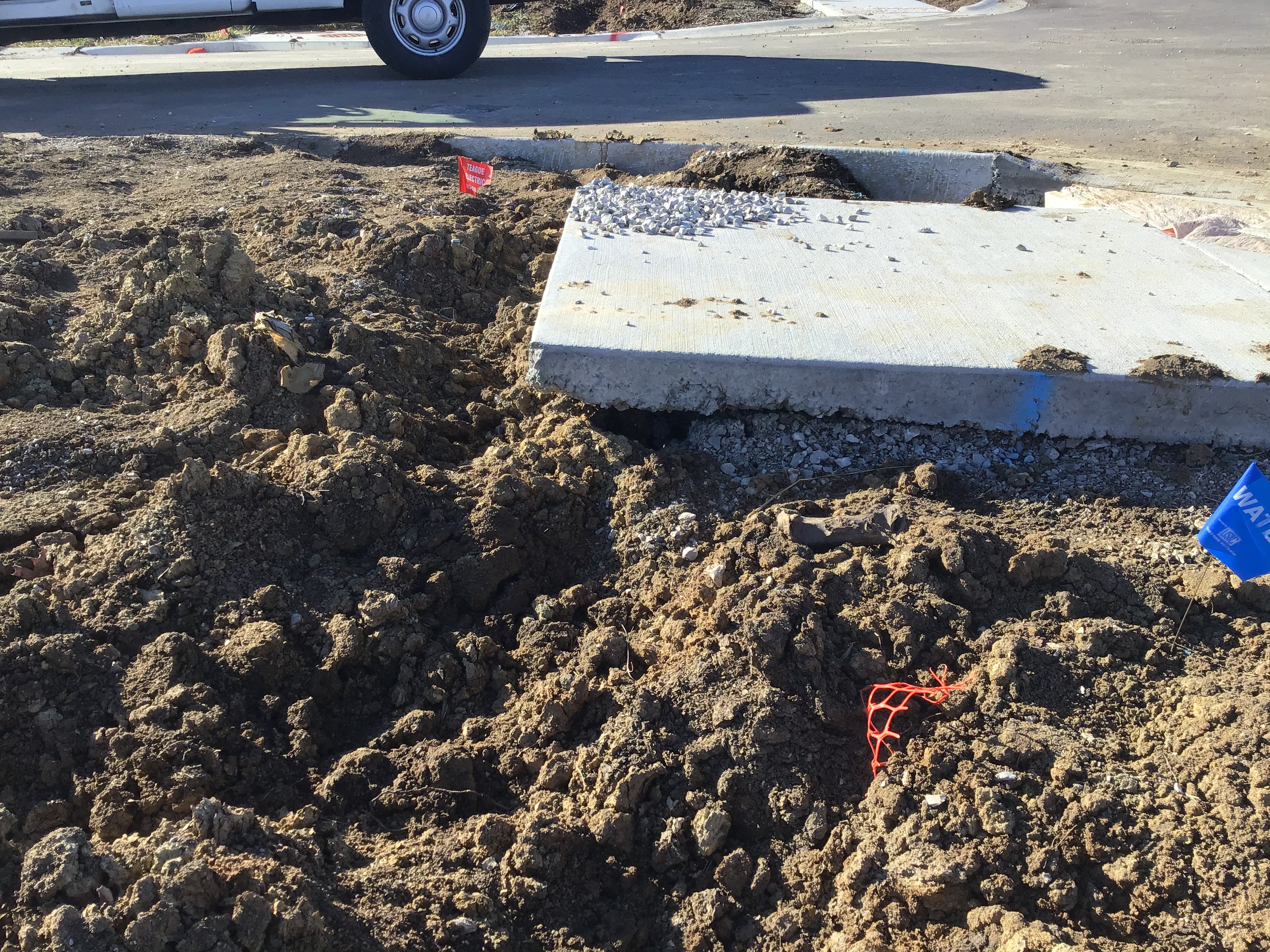

Spalding Excavation is on site cutting grade for the roads. Ive asked the crew to bring in water trucks or other effective measures to control the dust leaving the site. The crew plans to have water trucks on site moving forward to control the dust.
Pavement-Stabilized Subgrade Passed 07/22/2020
Misc
Informational
07/22/2020
On Friday 7/17/2020 Steve Robbins was on site while Spalding Excavating installed the 4% Portland Cement sub grade for stabilization. He stated that the means and methods used for the install were in compliance. KC Testing was on site during the install for compaction testing and has provided us with the results.
Pavement-Proof Roll Failed 07/23/2020
Misc
Corrective Action Required
07/23/2020

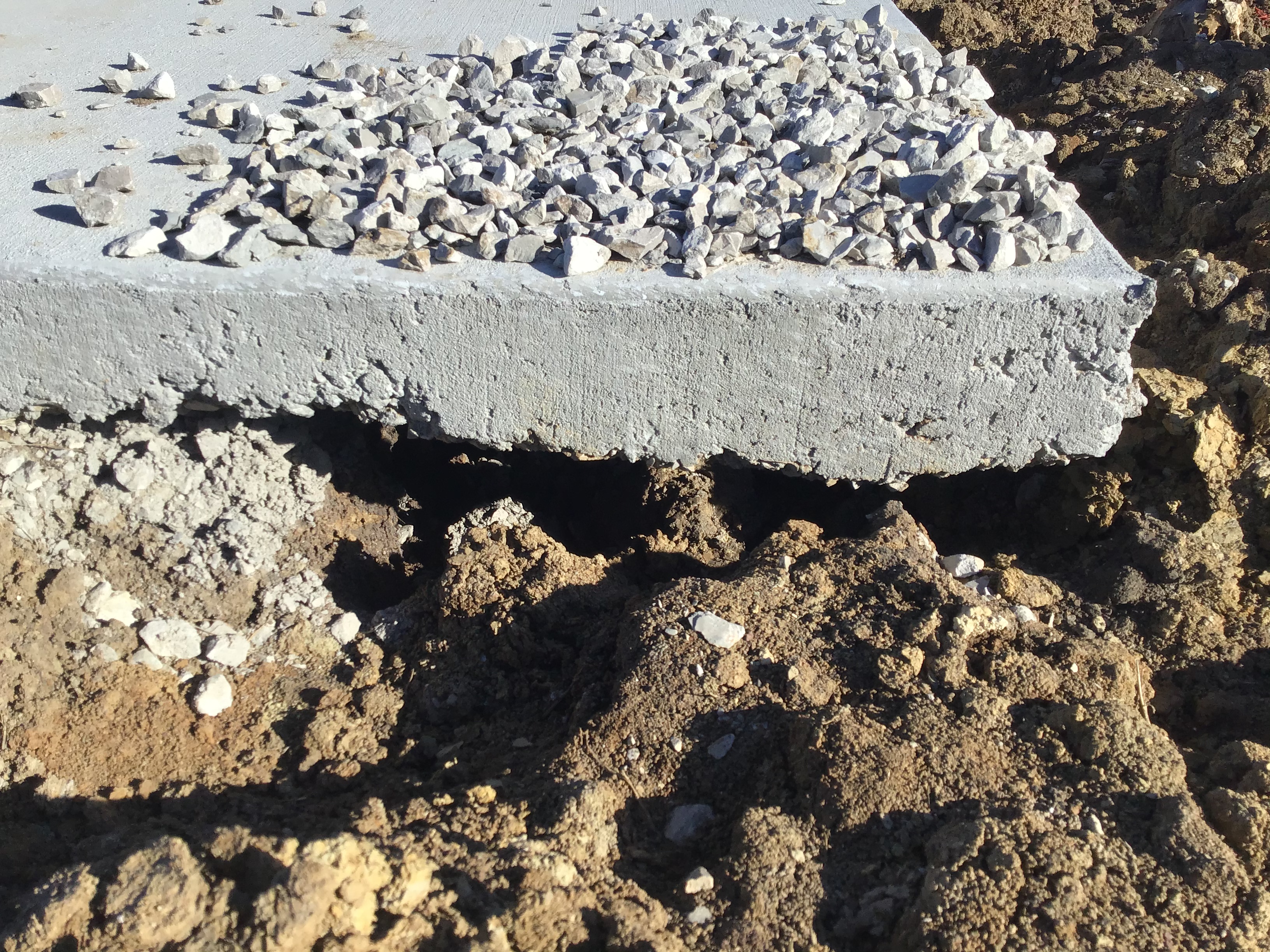

I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. There were a number of areas with deflection. The sub grade still needs more time to cure out.
Pavement-Proof Roll Partial 07/24/2020
Misc
Corrective Action Required
07/23/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. There were a number of areas with deflection. The sub grade still needs more time to cure out.
Misc
Informational
07/24/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. The roll test passed with no deflection. The crew plans to install the base rock layer next week.
Pavement-Proof Roll Passed 08/04/2020
Misc
Corrective Action Required
07/24/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. There were a number of areas with deflection. The sub grade still needs more time to cure out.
Misc
Informational
07/24/2020
I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. The roll test passed with no deflection. The crew plans to install the base rock layer next week.
Misc
Informational
08/04/2020
John DiMauro 8/4/2020 After the heavy rain event over the weekend, another proof roll was required. I observed the proof roll for the Portland Cement treated sub grade prior to the aggregate going in. The roll test passed with no deflection. The crew plans to install the base rock layer next week.
Curb - Proof Roll Passed 08/13/2020
Misc
Informational
08/13/2020
I observed the proof roll of the aggregate base for the curbs. I verified the correct load weight and the roll test passed with no deflection.
Storm Sewer Construction Inspection Passed 08/13/2020
Misc
Resolved
08/13/2020
The Redford Crew started on the storm sewer line 5 today. The crew stubbed into existing field inlet 5-6 and ran approx 20’ ft of pipe out of it to the north. The crew was preparing to pour the collar for the penetration later today. I will return for further inspection tomorrow 5/14/20.
Misc
Resolved
08/13/2020
The Redford crew has the storm sewer line 5 run from station 0+00 to approx 2+5. The crew poured the collar for the existing field inlet 5-6 yesterday. The crew set field inlet 5-1 and plans to pour the rest of the collars today once the line 5 is installed. Photos of the work are uploaded. I will return this afternoon for further inspection.
Misc
Resolved
08/13/2020
The crew completed the storm line 5 install. The collars and inverts were poured in both field inlets 5-1 & 5-2. The crew is going to grout the inside of the boxes once the lids are secured on. Photos of the work are uploaded to the system.
Misc
Resolved
08/13/2020
The Redford crew is working on storm line 1. The crew set the flared end section at station 0+00 in the detention basin and is running the 36” HDPE to the north. The crew has installed approximately 100’ ft of the line. Photos of the work are uploaded into the system. I will return this afternoon for further inspection.
Misc
Resolved
08/13/2020
The Redford crew ran the storm line 1 to station 1+81.73 and set both curb inlets 1-2 & 1-3. Photos of the work are uploaded.
Misc
Resolved
08/13/2020
The crew poured the collars and invert for curb inlet 1-2 & 1-3. Photos of the work are uploaded into the system.
Misc
Resolved
08/13/2020
The Storm line 1 is installed. The crew set boxes 1-4 & 1-5 today and poured the collars for the boxes. The also installed storm line 2 from FI 1-4 to FI 2-1. The crew poured the collar for FI 2-1 as well. They plan on pouring inverts tomorrow.
Misc
Resolved
08/13/2020
The Redford crew continued the Storm Line 2 install. The crew installed the line from station 0+00 to FI 2-1 at station 1+15.57 The poured inverts for field inlets 1-4, 1-5 & 2-1. Photos of the work are uploaded.
Misc
Resolved
08/13/2020
The Redford crew continued the storm line 2 install. Photos of the work have been uploaded.
Misc
Resolved
08/13/2020
The Redford Crew installed storm line 2 from FI 2-2 to CI 2-3 & storm line 4 from CI 2-3 to CI 4-1. The crew plans to complete the storm sewer install tomorrow and pour the remaining collars and inverts tomorrow. Photos of the work have been uploaded.
Misc
Resolved
08/13/2020
The Redford crew poured the storm inverts for inlets 2-1, 2-2, 2-3 & 4-1 this morning. Photos of the work are uploaded. The crew plans to finish up the storm line 2 run today. I will return for further inspection today.
Misc
Resolved
08/13/2020
The Redford crew completed the storm sewer install for The Manor. The crew set storm box 2-4 and installed the remainder of storm line 2 from 2-3 to 2-4. Inverts & collars have been poured and the lids are set. The crew is moving over to The Reserve side. Photos of the work have been uploaded.
Misc
Informational
08/13/2020
Redford Construction has a crew on site to repair the 6 damaged curb inlet structures. The repairs appear to be acceptable according to the discussion I had with Steve Robbins on a repair solution. Photos of the repairs are uploaded.
Public Curb Inspection Partial 08/19/2020
Misc
Informational
08/19/2020

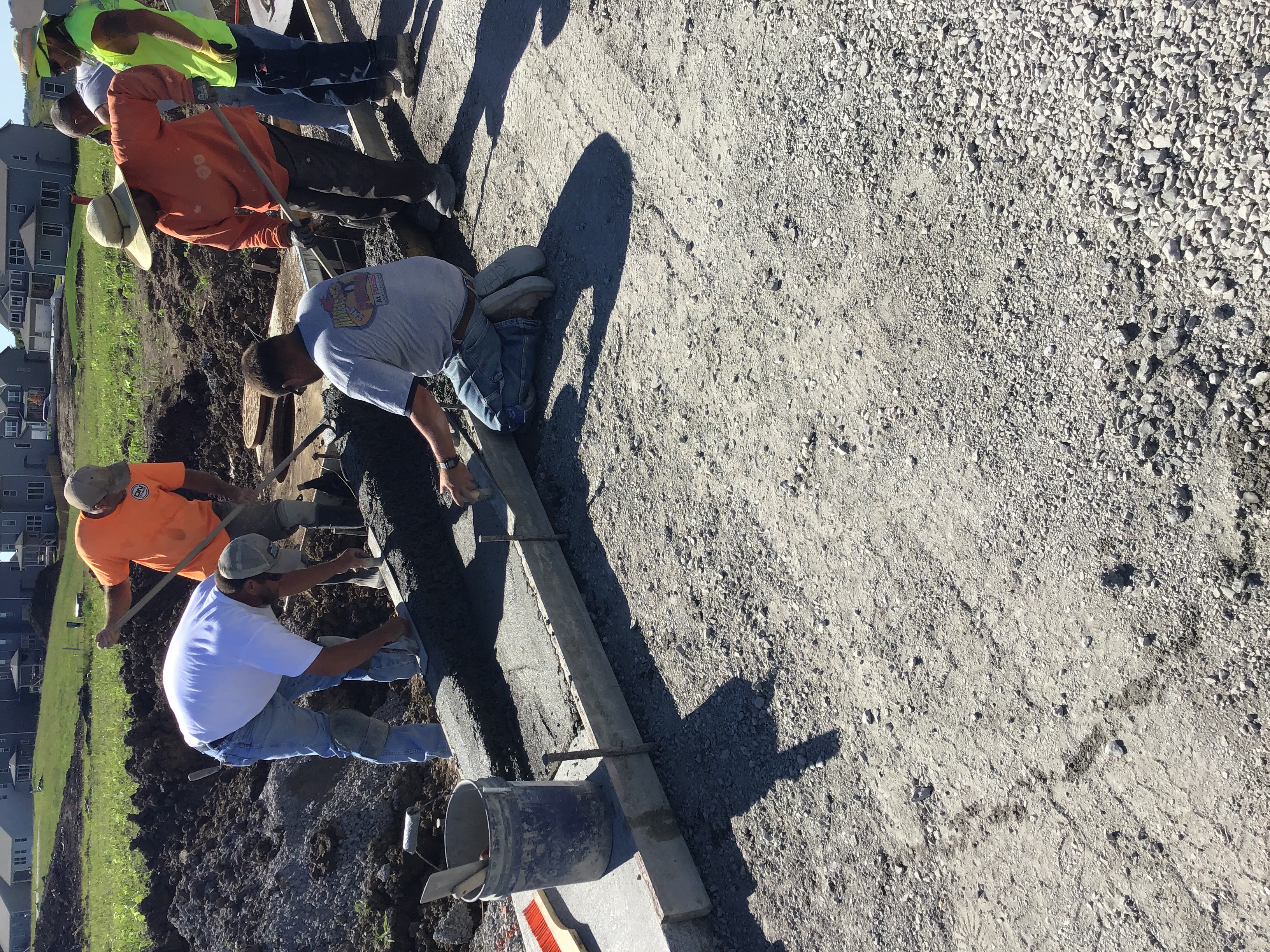

John DiMauro 8/19/2020 8:55 AM JK Concrete is on site installing the public curbs. I have verified the correct concrete mix being used. The practices being used comply. KC Testing lab is on site pulling concrete samples every 50 cubic yards. We will be provided with the testing results.
Public Curb Inspection Partial 08/20/2020
Misc
Informational
08/19/2020
John DiMauro 8/19/2020 8:55 AM JK Concrete is on site installing the public curbs. I have verified the correct concrete mix being used. The practices being used comply. KC Testing lab is on site pulling concrete samples every 50 cubic yards. We will be provided with the testing results.
Misc
Informational
08/20/2020
John DiMauro 8/20/2020 10:21 AM The JK Concrete crew poured the public road curbs yesterday and is on site pouring the curb inlet throats today. I am on site verifying the correct concrete mix type and the methods used for the install. Photos are uploaded.
Pavement-Proof Roll Passed 08/25/2020
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 8:25 AM Yesterday 8/24/2020 I observed the proof roll test of the aggregate sub-grade. The roll test passed with no deflection. Superior Bowen plans to pave the base and surface layers starting tomorrow.
Sanitary Sewer Construction Inspection Partial 08/25/2020
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 2:21 pm Redford Construction is on site making corrections to the SS manholes that were called out by Water Utilities camera inspection. I will take photos of the work once its complete.
Pavement-Surface Passed 8/27/2020 8/27/2020 08/27/2020
Misc
Informational
08/27/2020

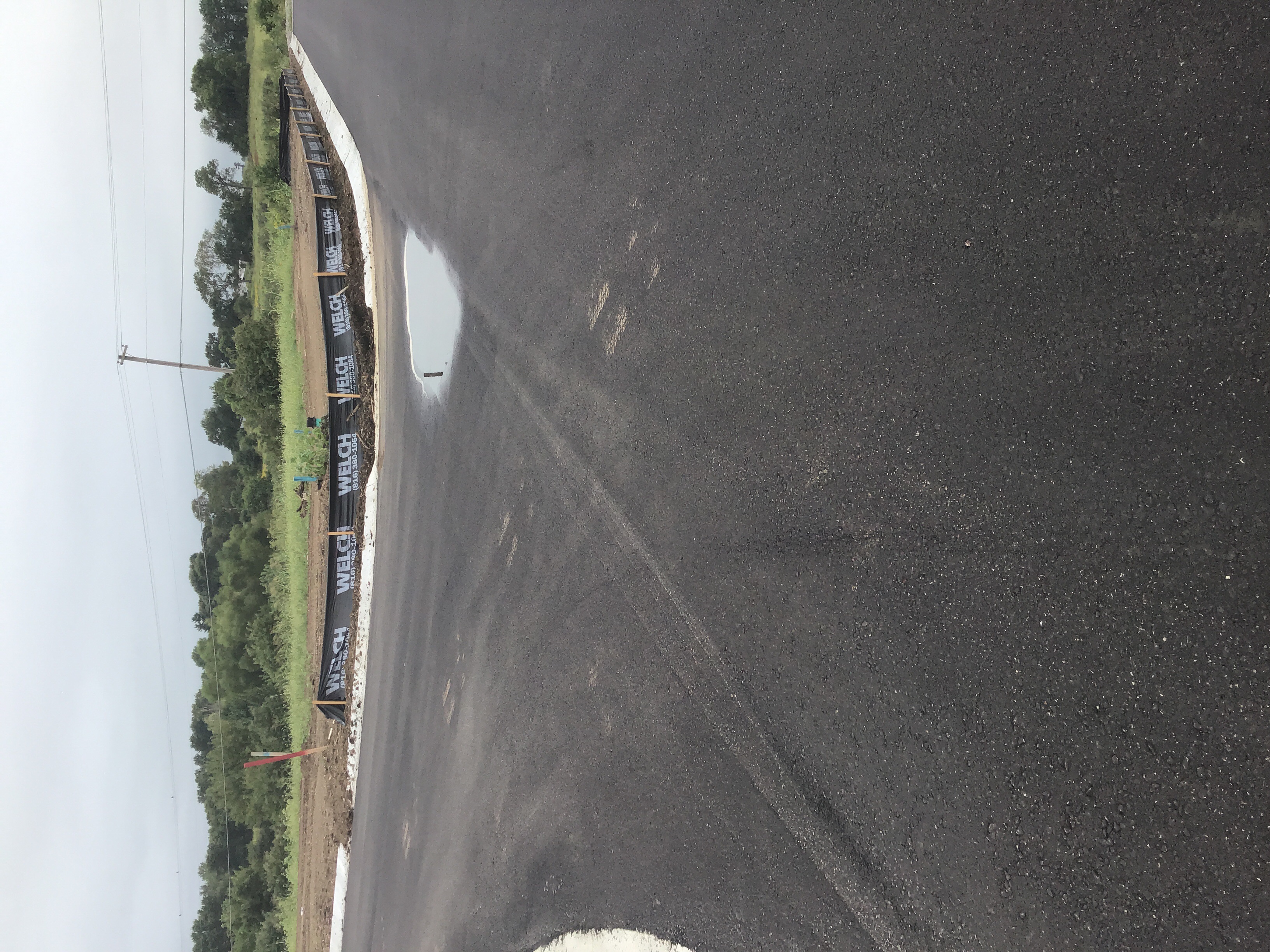

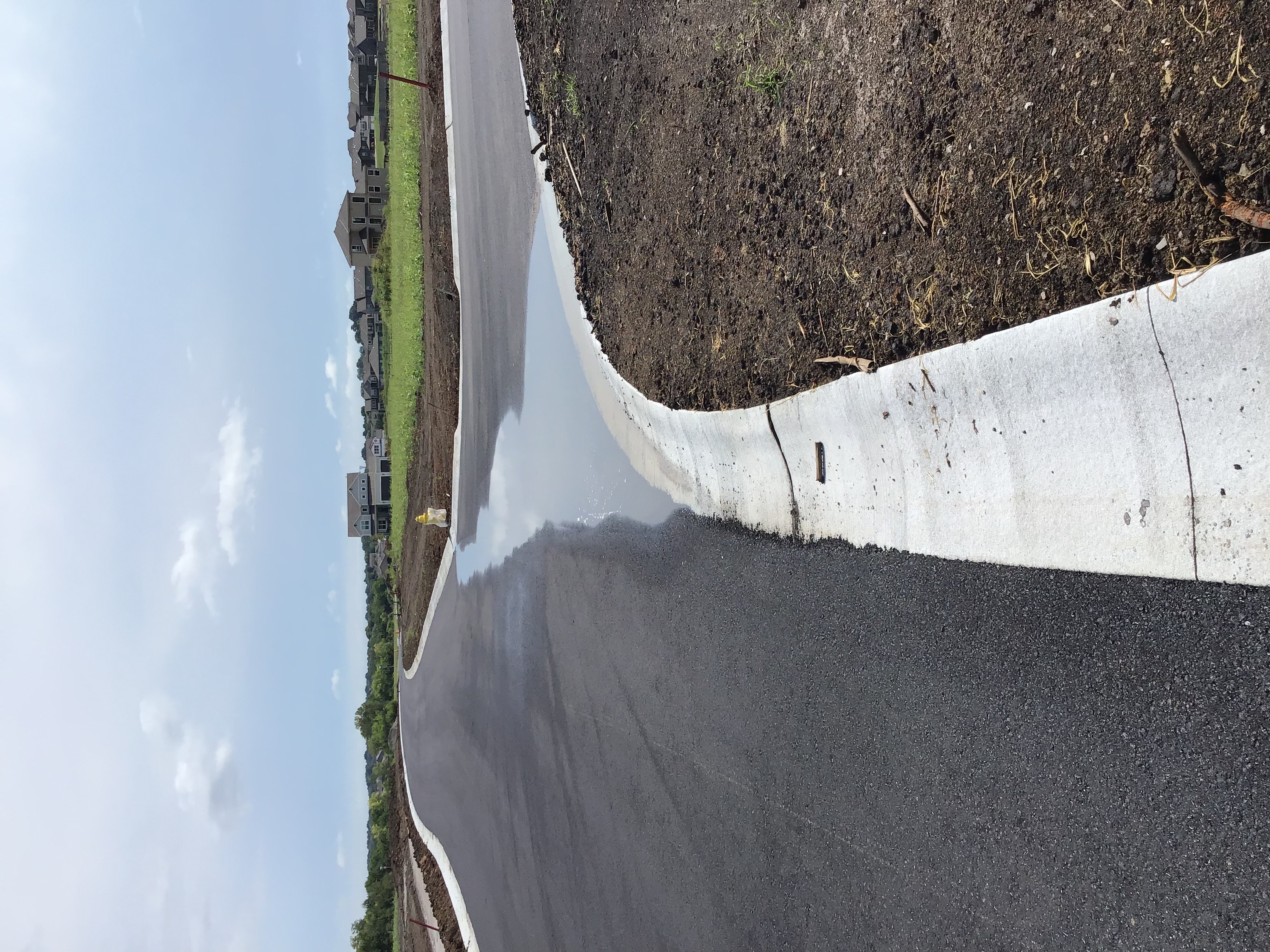

John DiMauro 8/27/2020 Yesterday 8/26 Superior Bowen was on site and installed the base lift for the subdivision roads. I verified the correct mix type was used and the temperatures and methods used for the install were in compliance.
Erosion Control Inspection Failed 08/31/2020
Misc
Resolved
08/31/2020
The construction entrances for both The Manor & Reserve at Stoney creek need to be re-established. Silt and mud is running off site and into the storm water collection system. Make corrections asap.
Misc
Corrective Action Required
08/31/2020

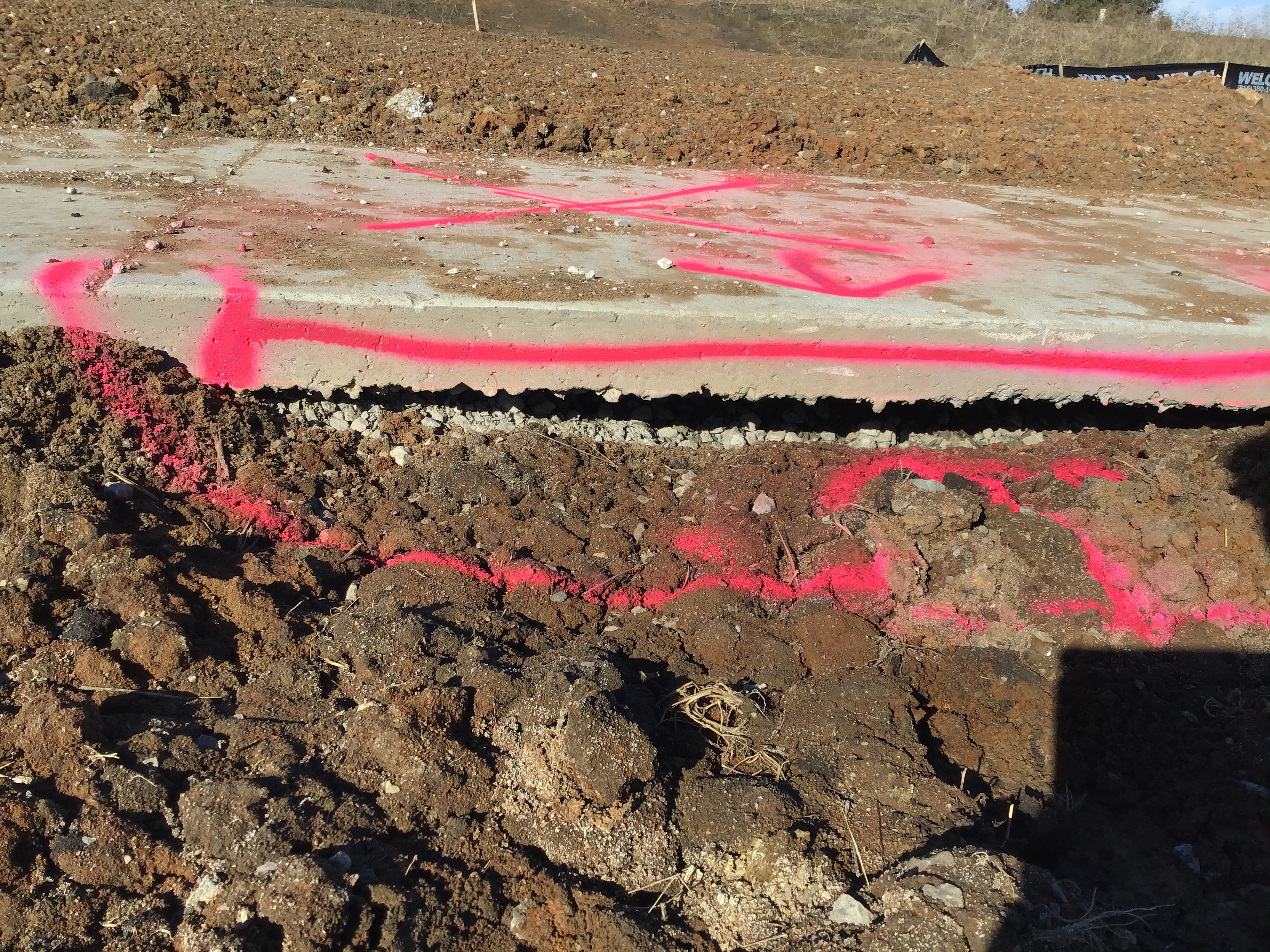

John DiMauro 8/31/2020 8:25 AM EROSION CONTROL INSPECTION Install erosion control devices on site according to the ESC PHASE 2 SHEET C.051 Take additional ESC measures that are not called out on the plans in the low lying areas that will allow for silt and sediment to leave the site. Make these corrections asap.
Street - Surface Course Failed 09/08/2020
Misc
Corrective Action Required
09/08/2020
John DiMauro 9/8/2020 11:15 AM An area of the street has been identified as defective and is not allowing water to properly drain. The area is at the intersection of SW Georgetown DR & SW Merryman DR. Corrective action is required as soon as possible. Photos of the ponding area are uploaded to the permit. Additionally, the road entrances need to be properly blocked off to keep traffic out of the areas until the streets are complete and have been accepted for use. Examples include street signs installed and and any repairs needed.
Sidewalk Inspection Partial 09/17/2020
Misc
Informational
09/17/2020
John DiMauro 9/17/2020 8:13 AM JK Concrete is on site forming the common area sidewalk along SW Georgetown DR. I observed the crew install the base rock and forms. There is sufficient base aggregate installed. I collected concrete tickets. Photos are uploaded.
ADA Inspection Partial 09/23/2020
Misc
Informational
09/23/2020
John DiMauro 9/23/2020 3:21 PM JK Concrete is on site working ton the ADA Ramps. I will do a post pour inspection at a later date.
Water Line - Construction Inspection Partial 09/26/2020
Misc
Informational
09/26/2020

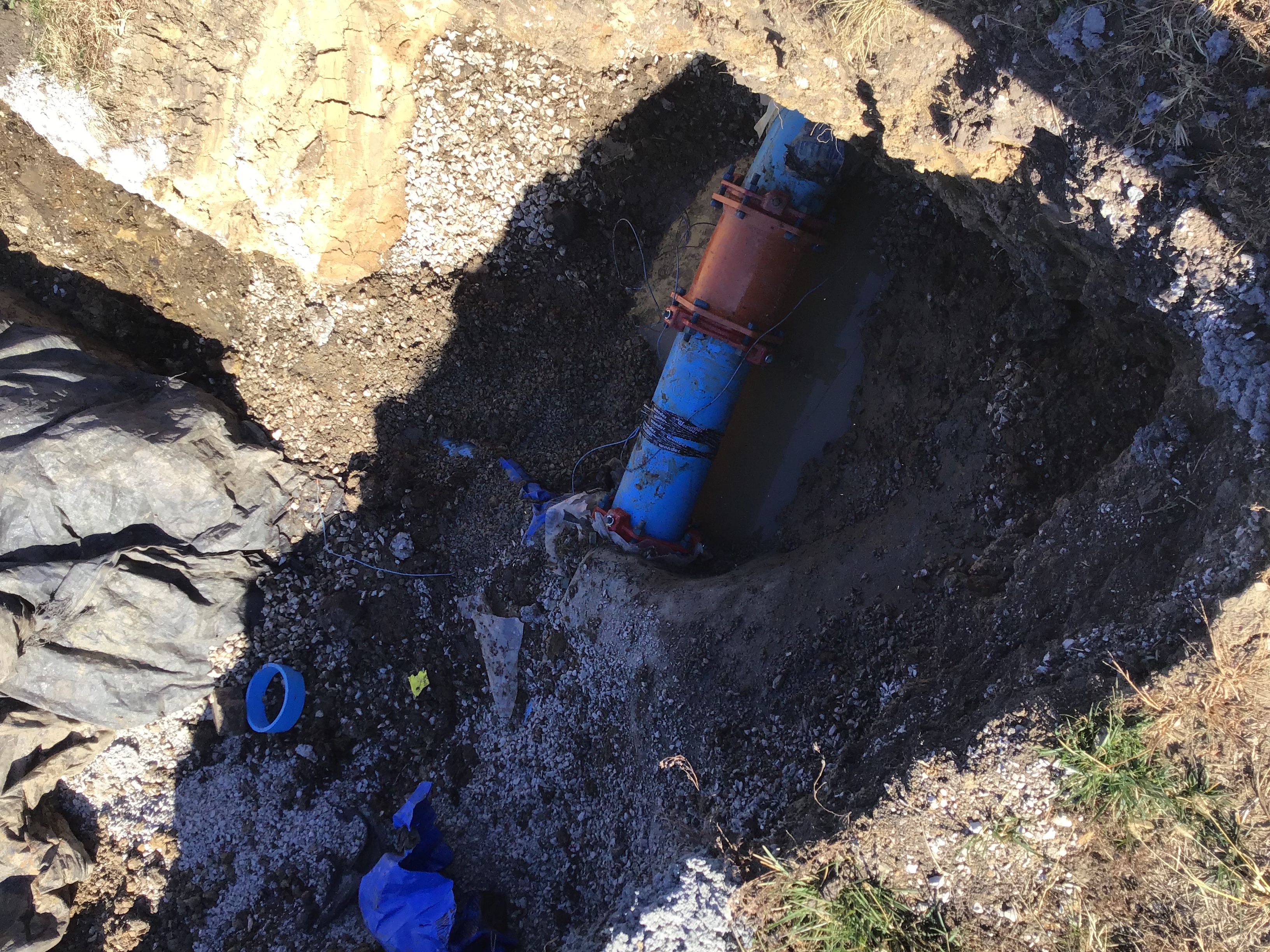

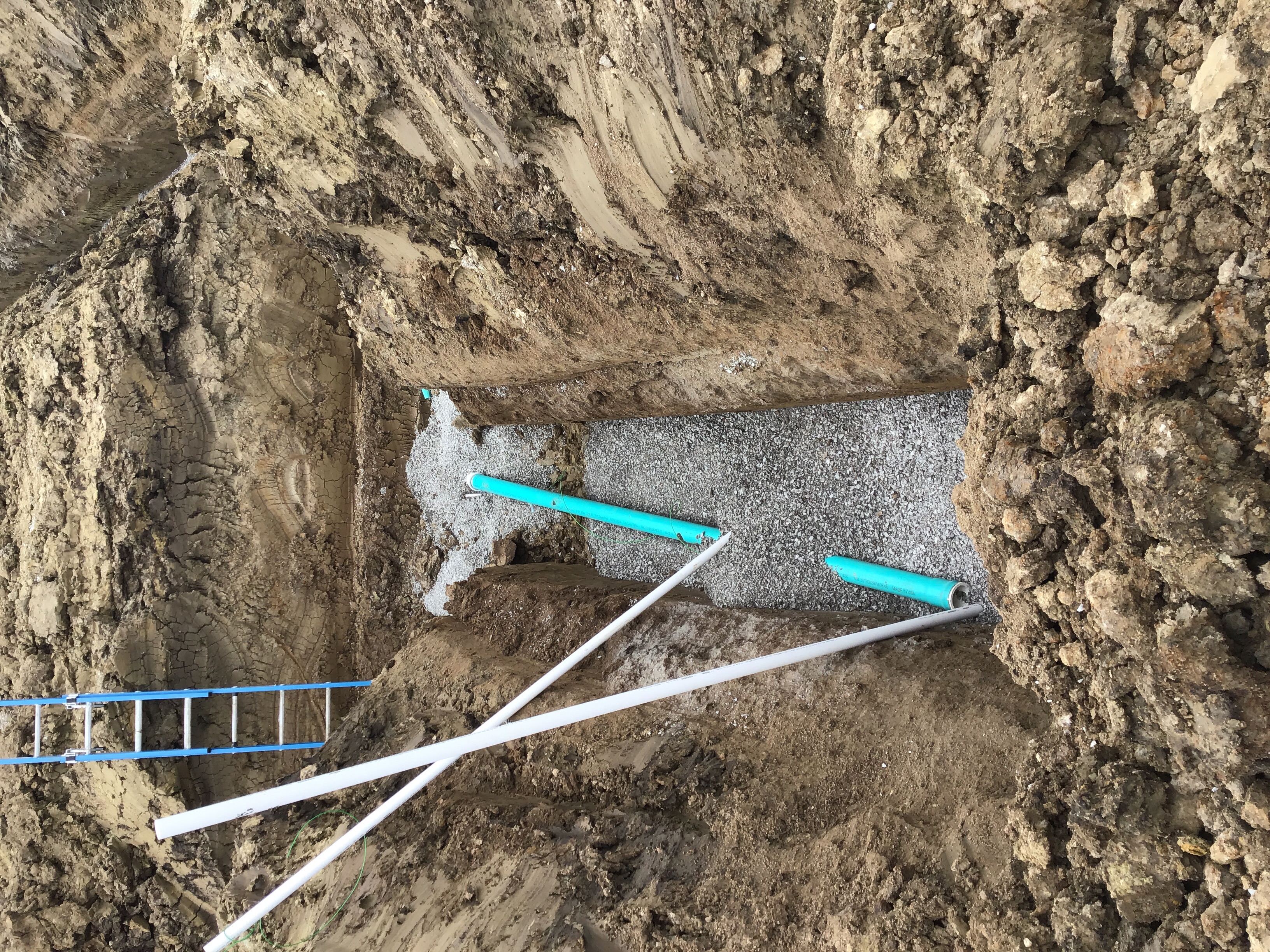

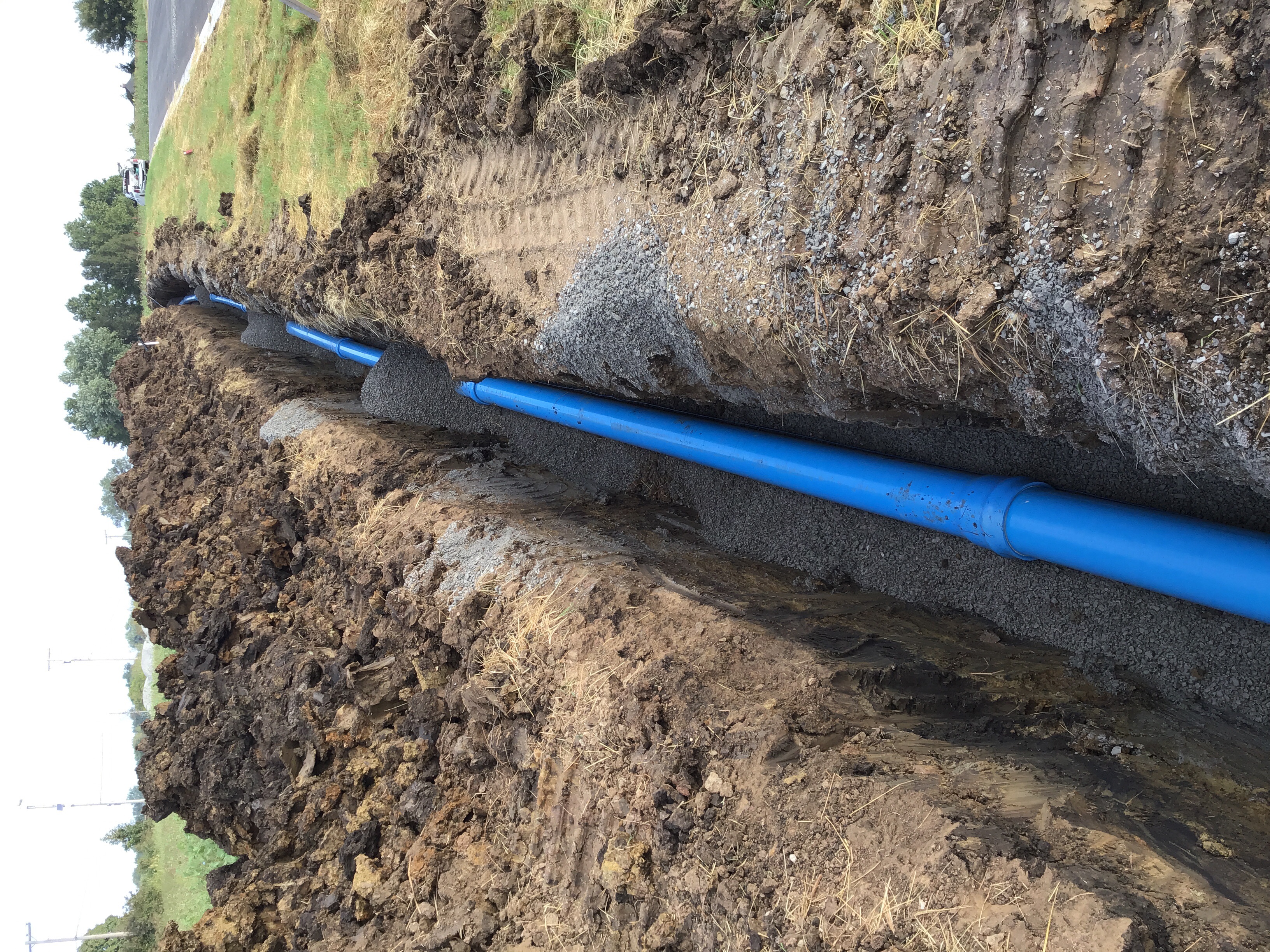

John DiMauro 9/26/2020 11:00 AM - AFTER HOURS INSPECTION The Redford crew is working on the water line 2 install. The crew has the line installed to approx 3+32. Photos are uploaded.
Water Line - Construction Inspection Partial 09/29/2020
Misc
Informational
09/29/2020

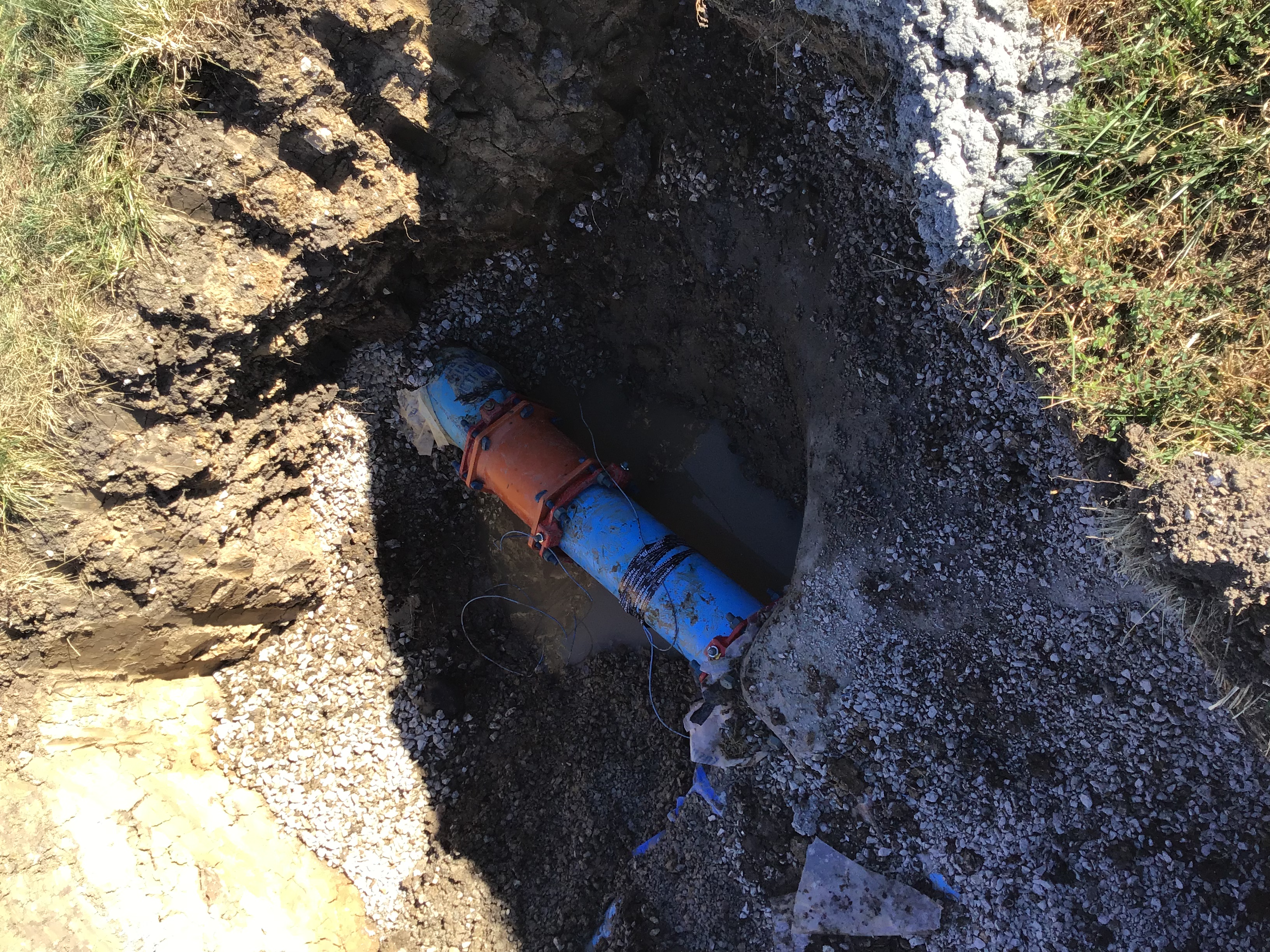

John DiMauro 9/29/2020 Water line 2 is installed. The crew poured the thrust blocks for the line yesterday. They plan to backfill today. Photos are uploaded.
ADA Inspection Failed 09/30/2020
Misc
Resolved
09/30/2020
John DiMauro 9/23/2020 3:21 PM JK Concrete is on site working ton the ADA Ramps. I will do a post pour inspection at a later date.
Misc
Corrective Action Required
09/30/2020
John DiMauro 9/30/2020 2:23 PM The Type B - ADA ramp at the southeast of SW Grindstone CIR & SW Georgetown DR is not constructed properly. There is not a sufficient turn around space beyond the detectable warning surface. Corrections to the ramp need to be made before acceptance from the City of Lee’s Summit. A photo of the ramp is uploaded.
ADA Inspection Passed 10/1/2020 10/1/2020 10/01/2020
Misc
Resolved
10/01/2020
John DiMauro 9/30/2020 2:23 PM The Type B - ADA ramp at the southeast of SW Grindstone CIR & SW Georgetown DR is not constructed properly. There is not a sufficient turn around space beyond the detectable warning surface. Corrections to the ramp need to be made before acceptance from the City of Lee’s Summit. A photo of the ramp is uploaded.
Misc
Informational
10/01/2020
John DiMauro 10/1/2020 9:36 AM *UPDATE* The Type B - ADA ramp at the southeast corner of SW Grindstone CIR & SW Georgetown DR is IN compliance. The detectable warning surface is allowed to be included in the required 4’ ft x 4’ ft turning space. No corrective action required.
Water Line - Hydrostatic Test Failed 10/12/2020
Misc
Corrective Action Required
10/12/2020

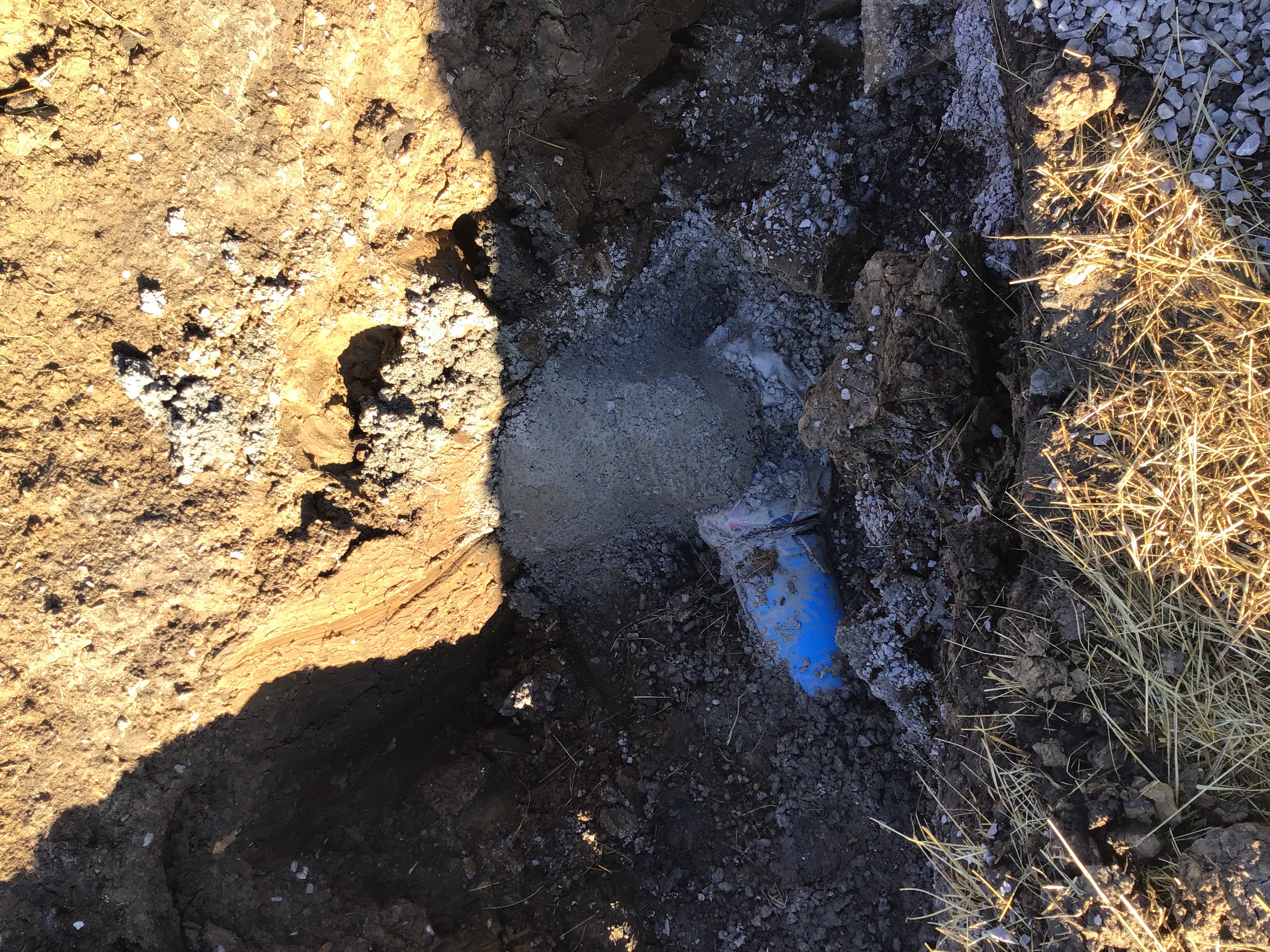

John DiMauro 10/12/2020 10:34 AM The initial hydrostatic test FAILED. The line dropped 5psi is the first 20 min of the test. The Redford crew is going to make corrections and then call for another inspection.
Water Line - Hydrostatic Test Passed 10/13/2020 10/13/2020 10/13/2020
Misc
Corrective Action Required
10/12/2020
John DiMauro 10/12/2020 10:34 AM The initial hydrostatic test FAILED. The line dropped 5psi is the first 20 min of the test. The Redford crew is going to make corrections and then call for another inspection.
Misc
Informational
10/13/2020
John DiMauro 10/13/2020 10:37 AM The Redford crew made corrections to the water line yesterday. A fitting at the end of the line came loose. I observed the hydro test today. The line held at 155 psi for two hours with no drop. Test Passed.
Water Line - Construction Inspection Partial 10/16/2020
Misc
Informational
09/29/2020
John DiMauro 9/26/2020 11:00 AM - AFTER HOURS INSPECTION The Redford crew is working on the water line 2 install. The crew has the line installed to approx 3+32. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 10/16/2020 8:11 AM The Redford crew chlorinated the water lines for the project. I verified that there was at least 25 PPM of chlorine at the ends of the lines with the test strips provided.
Water Line - Coliform Test 1 Partial 10/19/2020 at 8:00 AM 10/19/2020
Misc
Informational
10/19/2020
John DiMauro 10/19/2020 12:05 PM We collected the samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 2 Partial 10/20/2020 at 8:00 AM 10/20/2020
Misc
Informational
10/20/2020
John DiMauro 10/20/2020 1:30 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 2 Failed 10/22/2020
Misc
Informational
10/20/2020
John DiMauro 10/20/2020 1:30 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 1 Failed 10/22/2020
Water Line - Coliform Test 1 Partial 10/26/2020
Misc
Corrective Action Required
10/26/2020
John DiMauro 10/26/2020 11:30 AM I collected this round of day 1 samples and delivered them to Keystone Lab. We will know the results in 24 Hours.
Water Line - Coliform Test 2 Partial 10/27/2020
Misc
Informational
10/22/2020
John DiMauro 10/20/2020 1:30 PM We collected the day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Misc
Informational
10/27/2020
John DiMauro 10/70/2020 1:30 PM We collected the Second round of day 2 samples for the new water main install and delivered them to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 1 Passed 11/02/2020
Misc
Corrective Action Required
10/26/2020
John DiMauro 10/26/2020 11:30 AM I collected this round of day 1 samples and delivered them to Keystone Lab. We will know the results in 24 Hours.
Misc
Informational
11/02/2020
John DiMauro 11/2/2020 9:39 AM The Day 1 samples passed. Reports are uploaded.
Water Line - Coliform Test 2 Passed 11/02/2020
Misc
Informational
11/02/2020
John DiMauro 11/02/2020 The day 2 samples passed. Reports are uploaded.
Water Line - Construction Inspection Partial 11/02/2020
Misc
Informational
10/16/2020
John DiMauro 9/26/2020 11:00 AM - AFTER HOURS INSPECTION The Redford crew is working on the water line 2 install. The crew has the line installed to approx 3+32. Photos are uploaded.
Misc
Informational
10/16/2020
John DiMauro 10/16/2020 8:11 AM The Redford crew chlorinated the water lines for the project. I verified that there was at least 25 PPM of chlorine at the ends of the lines with the test strips provided.
Misc
Informational
11/02/2020
John DiMauro 11/02/2020 3:00 PM The Redford crew completed the tie-ins for the water main on SW Georgetown and SW Merryman. After the install we flushed the line according to the flow chart. The water main lines are now in service.
Sanitary Sewer Construction Inspection Partial 12/03/2020
Misc
Informational
08/25/2020
John DiMauro 8/25/2020 2:21 pm Redford Construction is on site making corrections to the SS manholes that were called out by Water Utilities camera inspection. I will take photos of the work once its complete.
Misc
Informational
12/03/2020
John DiMauro 12/03/2020 2:30 PM John DiMauro 8/25/2020 2:21 pm Redford Construction is on site making corrections to the SS manholes that were called out by Water Utilities Bond Inspection. I will take photos of the work once its complete.
Sidewalk Inspection Failed 02/17/2021
Misc
Corrective Action Required
01/21/2021

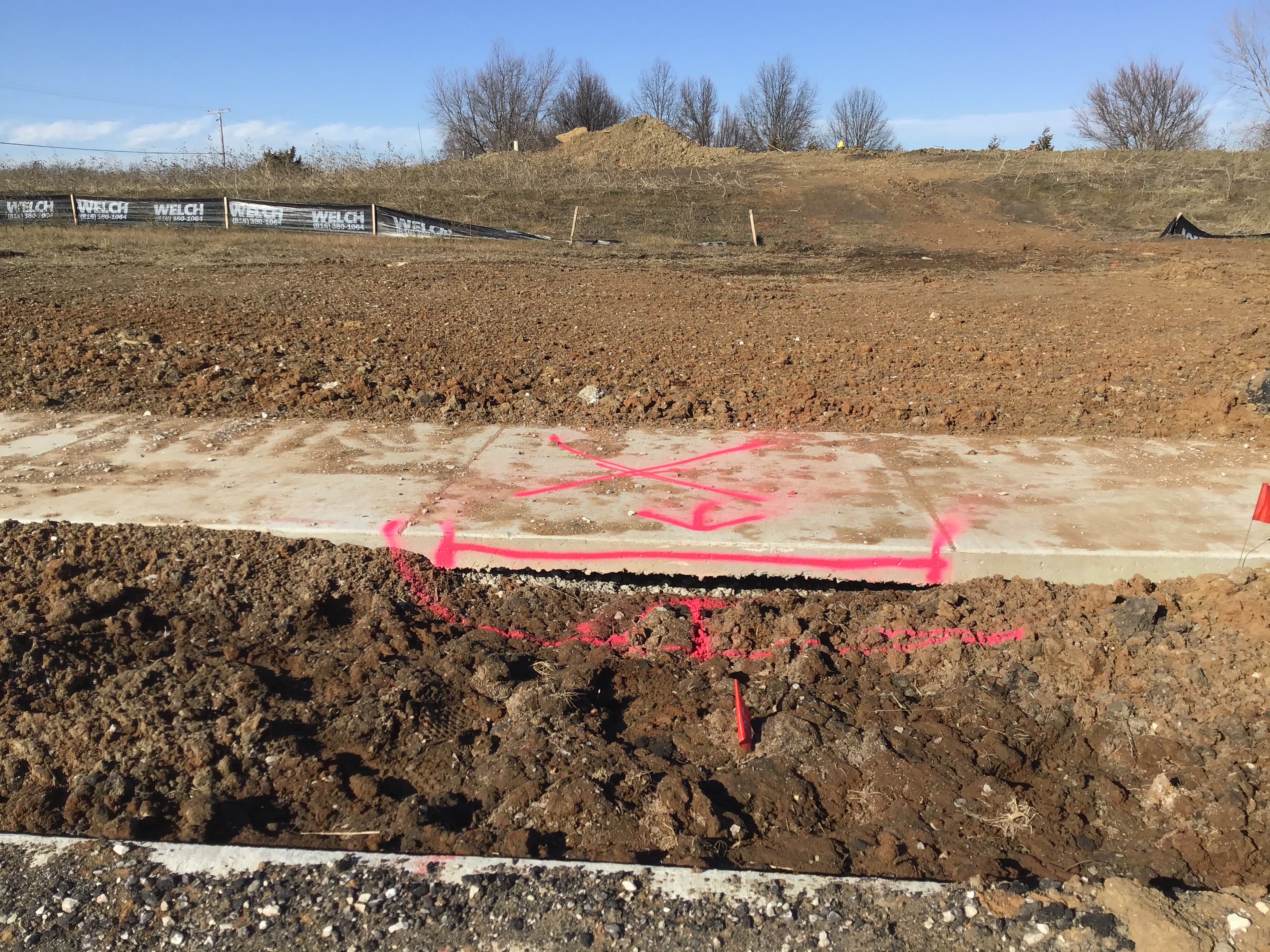

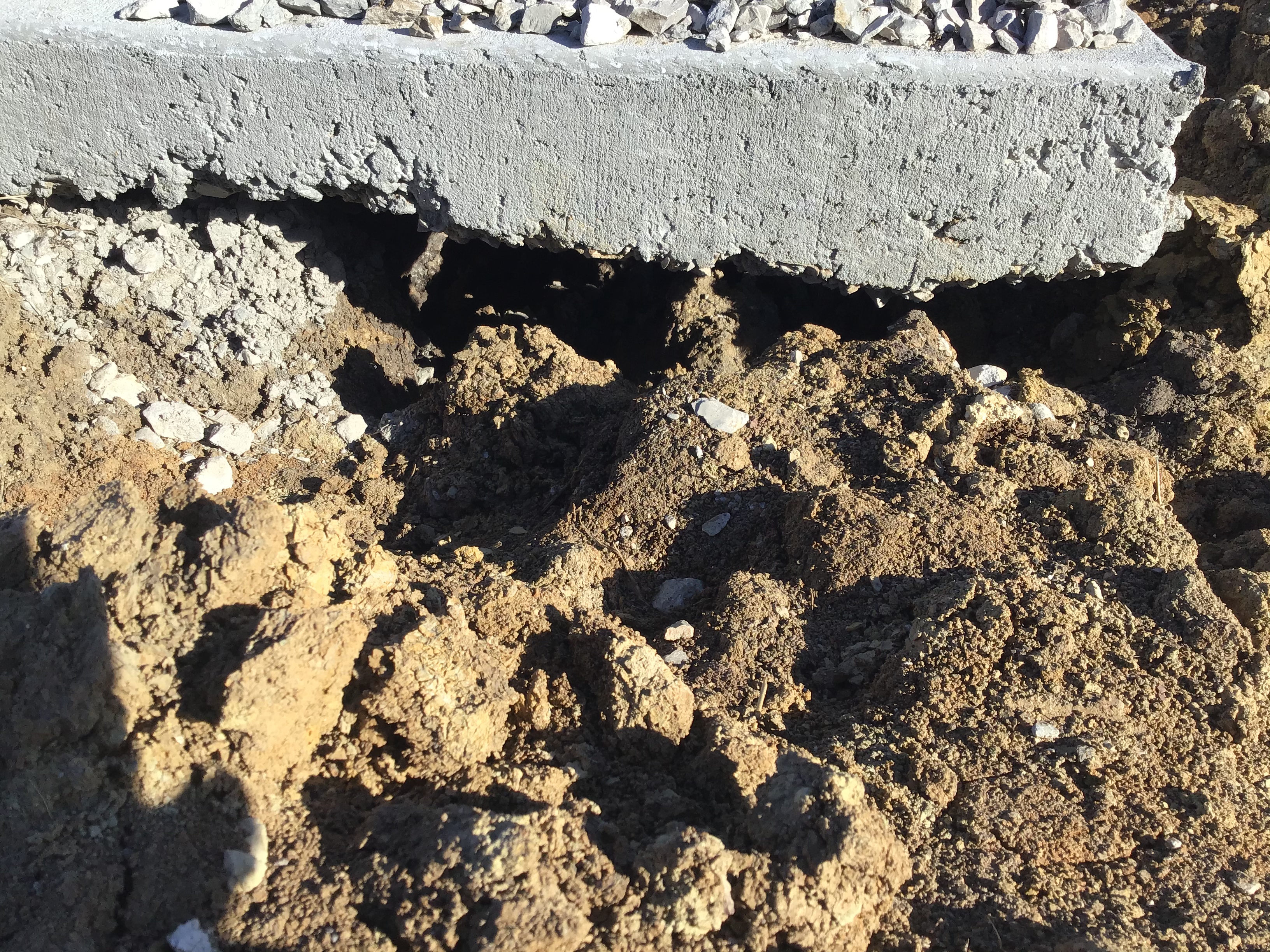

JOHN DIMAURO 1/21/2021 IT APPEARS THAT DURING THE EXCAVATION FOR THE ELECTRICAL CONDUITS, SECTIONS OF THE SIDEWALK AND ADA RAMPS WERE UNDERMINED AND ARE NO LONGER INSTALLED ON A SUITABLE SUB GRADE. THESE SECTIONS OF SIDEWALK WILL NEED TO BE REPLACED. PHOTOS ARE UPLOADED.
Storm - Swales Passed 05/18/2023
ESC - (Vegetation/Ground Cover) Passed 05/18/2023
Record Drawing Review Passed 10/15/2021 05/18/2023
Documents & Images
Date Uploaded File Type Document Name
07/15/2019 Receipt Receipt for transaction: 2019-004784
07/15/2019 Receipt Receipt for transaction: 2019-004785
10/03/2019 Receipt Receipt for transaction: 2019-006607
10/14/2019 Letter DE-Permit
10/14/2019 Letter DE-Permit
10/15/2019 Manor @ Stoney Creek 4th Plat Signed Permit
10/28/2019 Sanitary line from MH C-4
10/28/2019 Letter INSPECTION SUMMARY
10/28/2019 Letter DE-Permit
10/28/2019 Letter INSPECTION SUMMARY
10/29/2019 Line A sanitary
10/29/2019 Letter INSPECTION SUMMARY
03/19/2020 Letter INSPECTION SUMMARY
05/07/2020 Letter INSPECTION SUMMARY
05/07/2020 Sanitary MH B-1 Line 1 Connection
05/07/2020 Sanitary Line B-1
05/07/2020 Sanitary Line B-2
05/11/2020 Line B service lateral
05/11/2020 Line B service lateral
05/11/2020 Line B service lateral connections
05/11/2020 Line B service lateral connection
05/11/2020 Line B Service Lateral connection 0
05/11/2020 MH B-2 set and invert
05/11/2020 Letter INSPECTION SUMMARY
05/12/2020 Letter INSPECTION SUMMARY
05/12/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/13/2020 Letter INSPECTION SUMMARY
05/14/2020 Field inlet 5-1
05/14/2020 Storm line 5
05/14/2020 Letter INSPECTION SUMMARY
05/14/2020 Letter INSPECTION SUMMARY
05/14/2020 Letter INSPECTION SUMMARY
05/14/2020 FI 5-2 invert
05/14/2020 FI 5-1
05/14/2020 Letter INSPECTION SUMMARY
05/18/2020 Letter INSPECTION SUMMARY
05/18/2020 FES storm line 1
05/18/2020 FES storm line 2
05/18/2020 Storm line 1
05/18/2020 Storm line 2
05/18/2020 Storm line 3
05/18/2020 Letter INSPECTION SUMMARY
05/19/2020 FI 5-2 collar
05/19/2020 FI 5-1 collar
05/19/2020 FI 5-1 invert
05/19/2020 FI 5-2
05/19/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/20/2020 Storm line 4
05/20/2020 Storm line 1 FI 1-4
05/20/2020 Storm line 6
05/20/2020 Storm line 1 FI 1-3
05/20/2020 Collar concrete ticket
05/20/2020 Collar 2-1
05/20/2020 Collar box 1-4
05/20/2020 Collar 1-5
05/20/2020 Letter INSPECTION SUMMARY

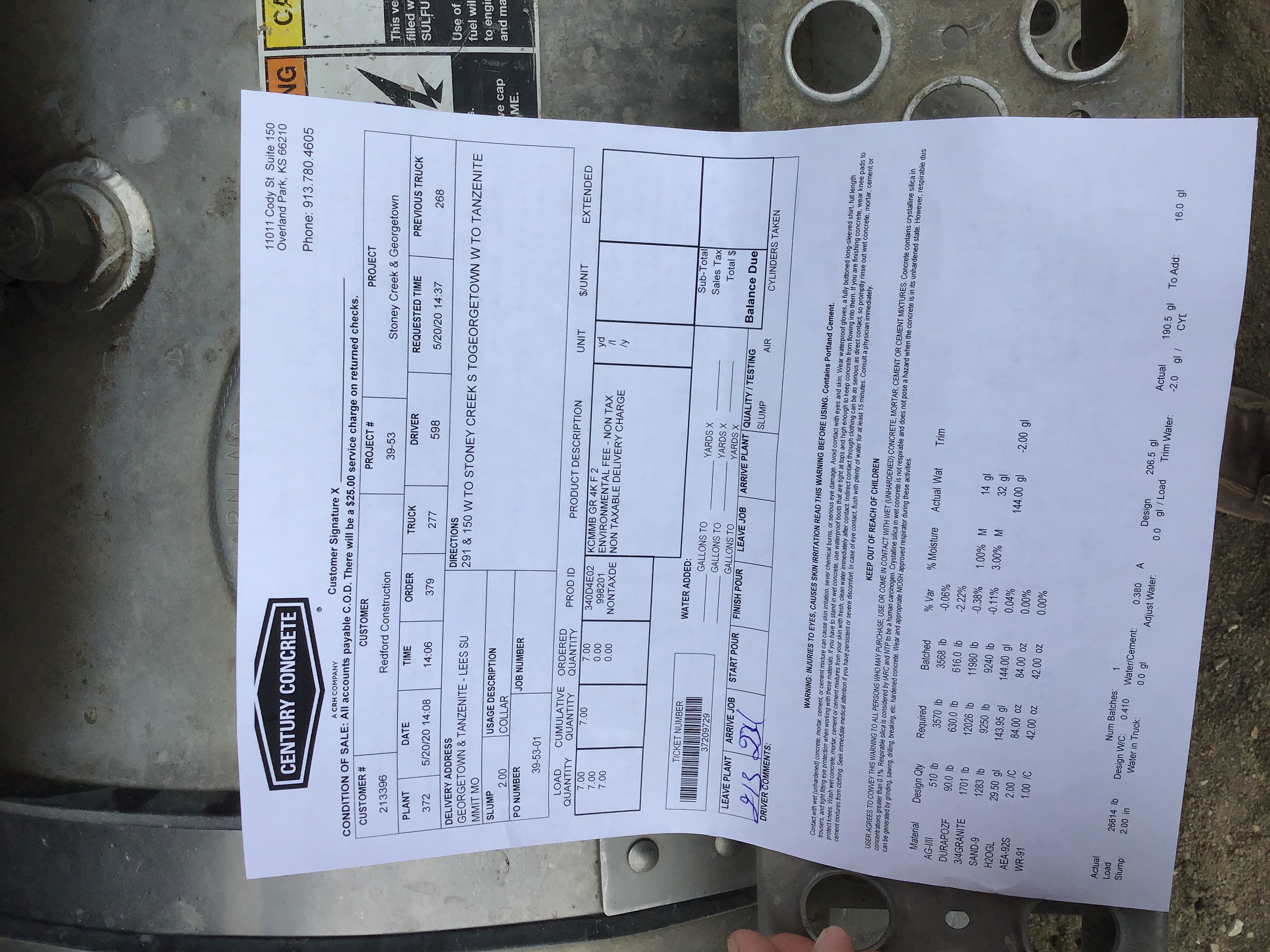

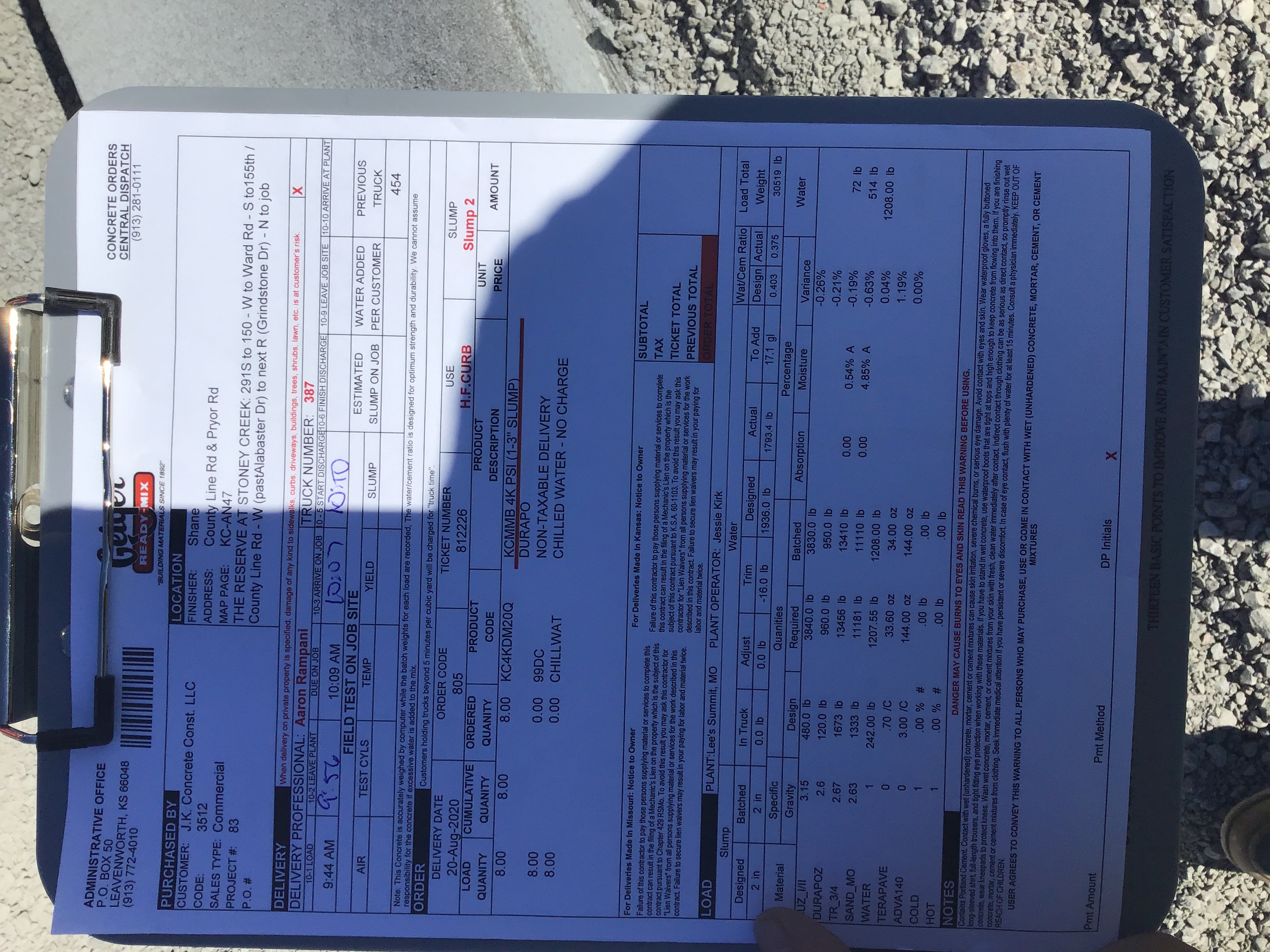

05/21/2020 Concrete ticket for storm inverts 1-4, 1-5 & 2-1
05/21/2020 Letter INSPECTION SUMMARY
05/21/2020 Invert FI 1-4
05/21/2020 FI 1-5 Invert
05/27/2020 Letter INSPECTION SUMMARY
05/28/2020 Letter INSPECTION SUMMARY
06/01/2020 Storm box 4-1.jpg
06/01/2020 Storm box 4-2.jpg
06/01/2020 Storm Curb inlet 2-3 .jpg
06/01/2020 Letter INSPECTION SUMMARY
06/02/2020 Storm inlet 2-1.jpg
06/02/2020 Storm inlet 2-2.jpg
06/02/2020 Storm inlet 4-1.jpg
06/02/2020 Letter INSPECTION SUMMARY
06/03/2020 Storm box 2-3 collars.jpg
06/03/2020 Storm box 2-4.jpg
06/03/2020 Letter INSPECTION SUMMARY
06/18/2020 Letter DE-Daily Inspection Summary
06/18/2020 Letter DE-Daily Inspection Summary
06/18/2020 Letter DE-Daily Inspection Summary
07/07/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/07/2020 Letter INSPECTION SUMMARY
07/22/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter INSPECTION SUMMARY
07/24/2020 Letter INSPECTION SUMMARY
08/04/2020 Letter INSPECTION SUMMARY
08/13/2020 Letter INSPECTION SUMMARY
08/13/2020 Letter INSPECTION SUMMARY
08/13/2020 Damaged CI 1.jpg
08/13/2020 Damaged CI 2.jpg
08/13/2020 Damaged CI 3.jpg
08/13/2020 Damaged CI 4.jpg
08/19/2020 Letter INSPECTION SUMMARY
08/20/2020 Concrete curb ticket.jpg
08/20/2020 Poured curb inlet.jpg
08/20/2020 CI install.jpg
08/20/2020 CI poured.jpg
08/20/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/25/2020 Letter INSPECTION SUMMARY
08/27/2020 Letter INSPECTION SUMMARY
08/31/2020 Letter INSPECTION SUMMARY
09/08/2020 Letter INSPECTION SUMMARY
09/08/2020 Street Ponding issue at intersection.jpeg
09/08/2020 Street ponding at intersection 2.jpg
09/17/2020 Letter INSPECTION SUMMARY
09/23/2020 Letter INSPECTION SUMMARY
09/26/2020 Water line 2 install.jpg
09/26/2020 Letter INSPECTION SUMMARY

09/29/2020 Hydrant 3+32.64.jpg
09/29/2020 Letter INSPECTION SUMMARY
09/29/2020 T block.jpg
09/29/2020 T block.jpg0
09/29/2020 T block.jpg1
09/29/2020 Roll hydrant.jpg
09/30/2020 Letter INSPECTION SUMMARY
09/30/2020 Failed Type B - ADA Ramp.jpeg
10/01/2020 Letter INSPECTION SUMMARY
10/12/2020 Letter INSPECTION SUMMARY
10/13/2020 Letter INSPECTION SUMMARY
10/16/2020 Letter INSPECTION SUMMARY
10/19/2020 Letter DE-Daily Inspection Summary
10/20/2020 Letter DE-Daily Inspection Summary
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/22/2020 Letter INSPECTION SUMMARY
10/26/2020 Letter INSPECTION SUMMARY
10/27/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 WO#1J02524 - City of Lees Summit Day 1 Water Samples .pdf
11/02/2020 WO#1J02670 - City of Lees Summit Day 2 water samples.pdf
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 Letter INSPECTION SUMMARY
11/02/2020 Water Main Tie in 1.jpeg
11/02/2020 Water main tie in 2.jpeg
11/02/2020 Water main tie in 3.jpeg
12/03/2020 Letter INSPECTION SUMMARY
01/15/2021 STREET AND STORM ASBUILTS
01/15/2021 WATER ASBUILTS
01/15/2021 SANITARY ASBUILTS
01/21/2021 1E7A579B-CF40-4F37-85A8-B759B5901C4B.jpeg
01/21/2021 E45E2063-6E11-44CA-B9D2-CF0D8F1E7D74.jpeg
01/21/2021 3821C32B-6D29-4ED8-A754-AD9514234EC3.jpeg
01/21/2021 04D3A44E-FBA9-434D-AE3B-1E8047D19C2F.jpeg
01/21/2021 CBD5CA45-F161-4BA4-A1E7-EF4017658B97.jpeg
01/21/2021 19E1A095-5DC4-4218-98EF-12B29604085B.jpeg
02/17/2021 Letter INSPECTION SUMMARY
04/01/2021 permit signed
05/26/2021 MANOR AT STONEY CREEK MDP 5-26-2021
09/30/2021 Manor At Stoney Creek 4th Plat Substantial Completion
09/30/2021 Manor At Stoney Creek 4th Plat Punch List
09/30/2021 Stoney Creek Manor 4th Maint Bond
10/08/2021 THE MANOR AT STONEY CREEK 4TH PLAT MDP 10-8-2021
02/16/2023 Stoney Creek 4th Plats Final Affidavits
05/18/2023 Letter DE-Certificate of Final Acceptance (Commercial)
05/18/2023 Manor at Stoney Creek 4th Plat Final Acceptance
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
