Permit Application Status

PRSUBD20184050

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSUBD20184050
Public Infrastructure
Final Acceptance
SUMMIT VIEW FARMS DEVELOPMENT GROUP LLC
DEVELOPMENT COMPLETE
SUMMIT VIEW FARMS 3RD PLAT SUBDIVISION IMPROVEMENTS
12/05/2018
01/02/2019
12/10/2022
07/27/2023
Locations
Address
3109 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3113 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3117 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3121 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3125 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3129 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3133 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3130 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3126 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3122 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3118 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3114 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3110 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
3106 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Address
2316 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2312 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2308 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2304 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2300 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2309 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2313 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
2317 SW CHASE CIR, LEES SUMMIT, MO 64082

Address
3105 SW BLUE RIBBON ST, LEES SUMMIT, MO 64082

Property
69520070800000000

Property
69520070700000000

Property
69520070600000000

Property
69520070500000000

Property
69520070900000000

Property
69520071000000000

Property
69520070200000000

Property
69520070300000000

Property
69520070400000000

Property
69520041100000000

Property
69520060700000000

Property
69520041000000000

Property
69520060800000000

Property
69520040900000000

Property
69520060900000000

Property
69520040800000000

Property
69520061000000000

Property
69520040700000000

Property
69520061100000000

Property
69520040600000000

Property
69520040500000000

Property
69520040400000000

Property
69520061400000000

Property
69520061500000000

Address
2305 SW CHASE CIR, LEES SUMMIT, MO 64082

Contacts
SUMMIT VIEW FARMS DEVELOPMENT GROUP LLC, Address:13450 E STATE ROUTE 150
SUMMIT VIEW FARMS DEVELOPMENT GROUP LLC, Address:13450 E STATE ROUTE 150
BACHTEL DERRICK & AMY, Address:2305 SW CHASE CIR
RITTER WILLIAM J & COLEEN M, Address:2309 SW CHASE CIR
DONAHOE MELINDA M & MICHAEL A, Address:2313 SW CHASE CIR
GRAVES THOMAS H & CASSIE V, Address:2317 SW CHASE CIR
BAKER ZACHARY & AMANDA, Address:2300 SW CHASE CIR
NEWMAN CURTIS & MEGAN, Address:2304 SW CHASE CIR
BAGWELL CHRISTOPHER J & DEVON L, Address:2308 SW CHASE CIR
HOCKER SCOTT & KRISTEN, Address:2312 SW CHASE CIR
CULBERTSON MITCH R & JESSICA N, Address:2316 SW CHASE CIR
BROCATO CLINT & KIMBERLY, Address:3105 SW BLUE RIBBON ST
NICK ZVACEK CONSTRUCTION LLC, Address:1009 INDUSTRIAL DR
ERICKSON SAMUEL & ASHLEY, Address:3113 SW BLUE RIBBON ST
JENSEN TERRY LEE & JULIE ELIZABETH, Address:3117 SW BLUE RIBBON ST
COLOGNA JERRI L, Address:3121 SW BLUE RIBBON ST
CAMPBELL DON & AMY, Address:3125 SW BLUE RIBBON ST
BAKER KYLE J & BAKER AMANDA R, Address:3129 SW BLUE RIBBON ST
SAGE ZACHERY & BRITTANY, Address:3133 SW BLUE RIBBON ST
SCHEFFLER MATTHEW & ALYSSA, Address:3106 SW BLUE RIBBON ST
NEVINS JUSTIN R & HALL A, Address:3110 SW BLUE RIBBON ST
NARELDA VISHWANATH & REDDY SMITHA EDULAKANTI MOHAN, Address:3114 SW BLUE RIBBON ST
SHEPPERD TELINA MARIE, Address:3118 SW BLUE RIBBON ST
CAMP AUSTIN ODELL & CATHERINE ALLIE, Address:3122 SW BLUE RIBBON ST
SWOBODA THOMAS & LAUREN, Address:3126 SW BLUE RIBBON ST
EVBOUMWAN OSAGLE & MULARSKI LAUREN, Address:3130 SW BLUE RIBBON ST
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 12/05/2018 01/02/2019
John DiMauro
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $2,621.85 $2,621.85 Paid 12/06/2018
91100C9-Water Insp Fee $3,472.95 $3,472.95 Paid 12/06/2018
9110072-Water Test Fee $800.00 $800.00 Paid 12/06/2018
9110068-Storm Fee $3,366.54 $3,366.54 Paid 12/06/2018
9110081-Paved Surface Inspection Fee $16,870.47 $16,870.47 Paid 12/06/2018
9110071-Site Grading Fee $3,272.70 $3,272.70 Paid 12/06/2018
9110068-Storm Fee $176.25 $176.25 Paid 06/26/2019
$3,542.79
Outstanding Fees Amount Paid Owing Date Paid

$0.00
Inspections
Inspection Outcome Requested Scheduled Date Inspected

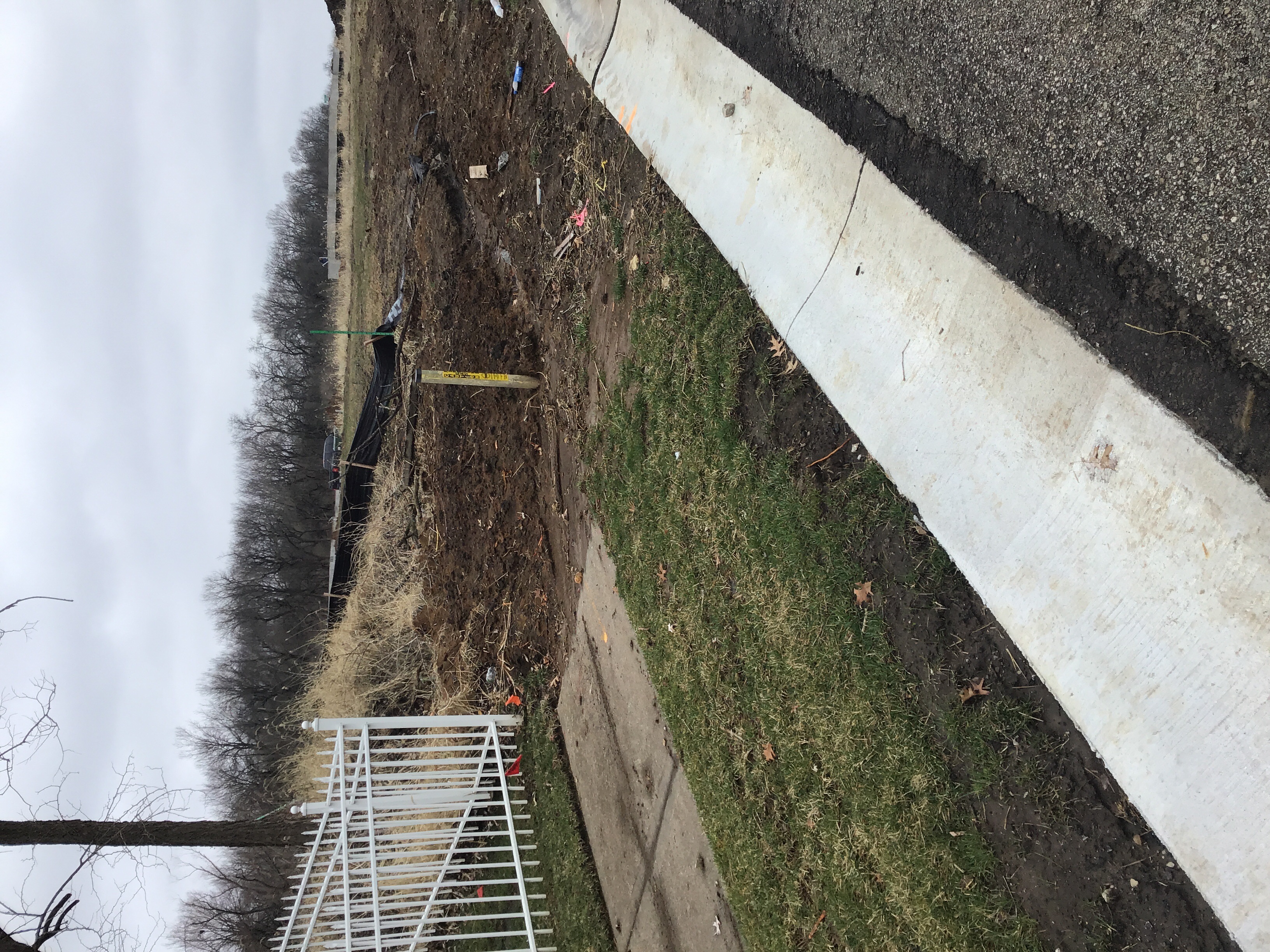

Erosion Control Inspection Partial 2/7/2019 03/05/2019
Misc
Corrective Action Required
03/05/2019

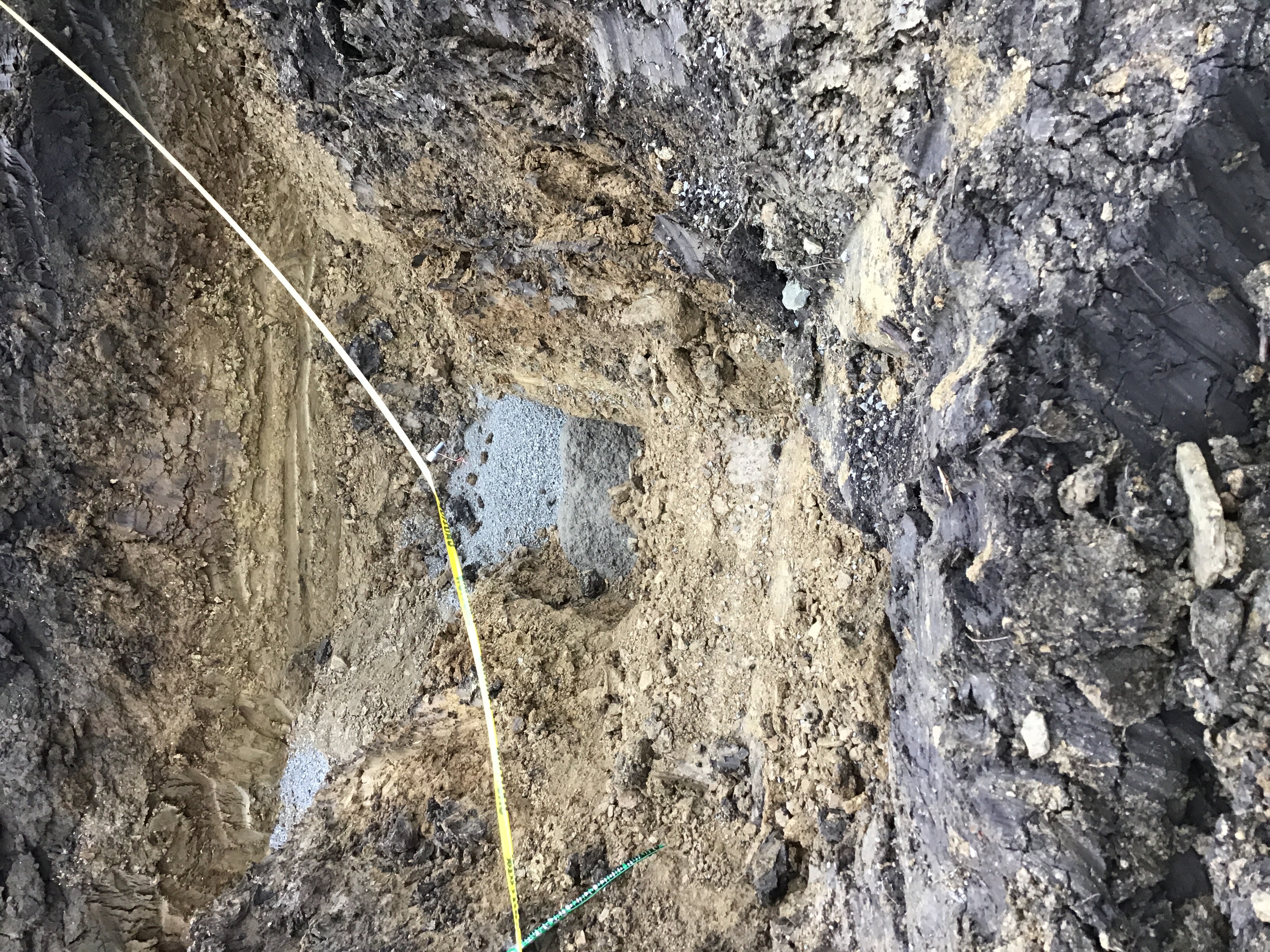

The silt fence along the west side of the property and the diversion berm along the south side appear to be installed according to the plans. The temporary sediment trap # 2 appears to be installed according to the plans. There are areas along the east side of the property that need to be corrected. There are low areas that still need self fence installed and the diversion berm needs to be corrected to properly direct flow into the trap.

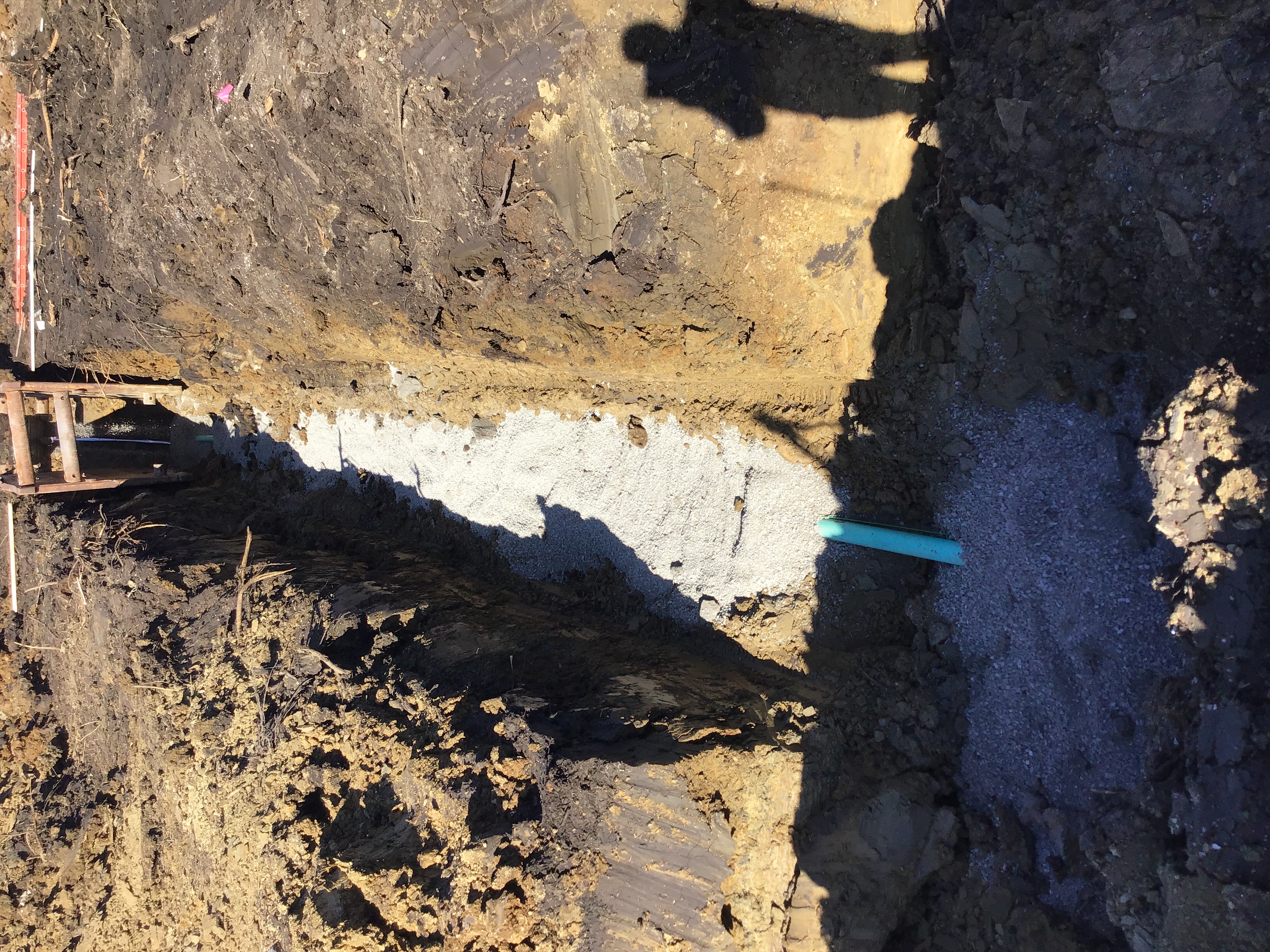

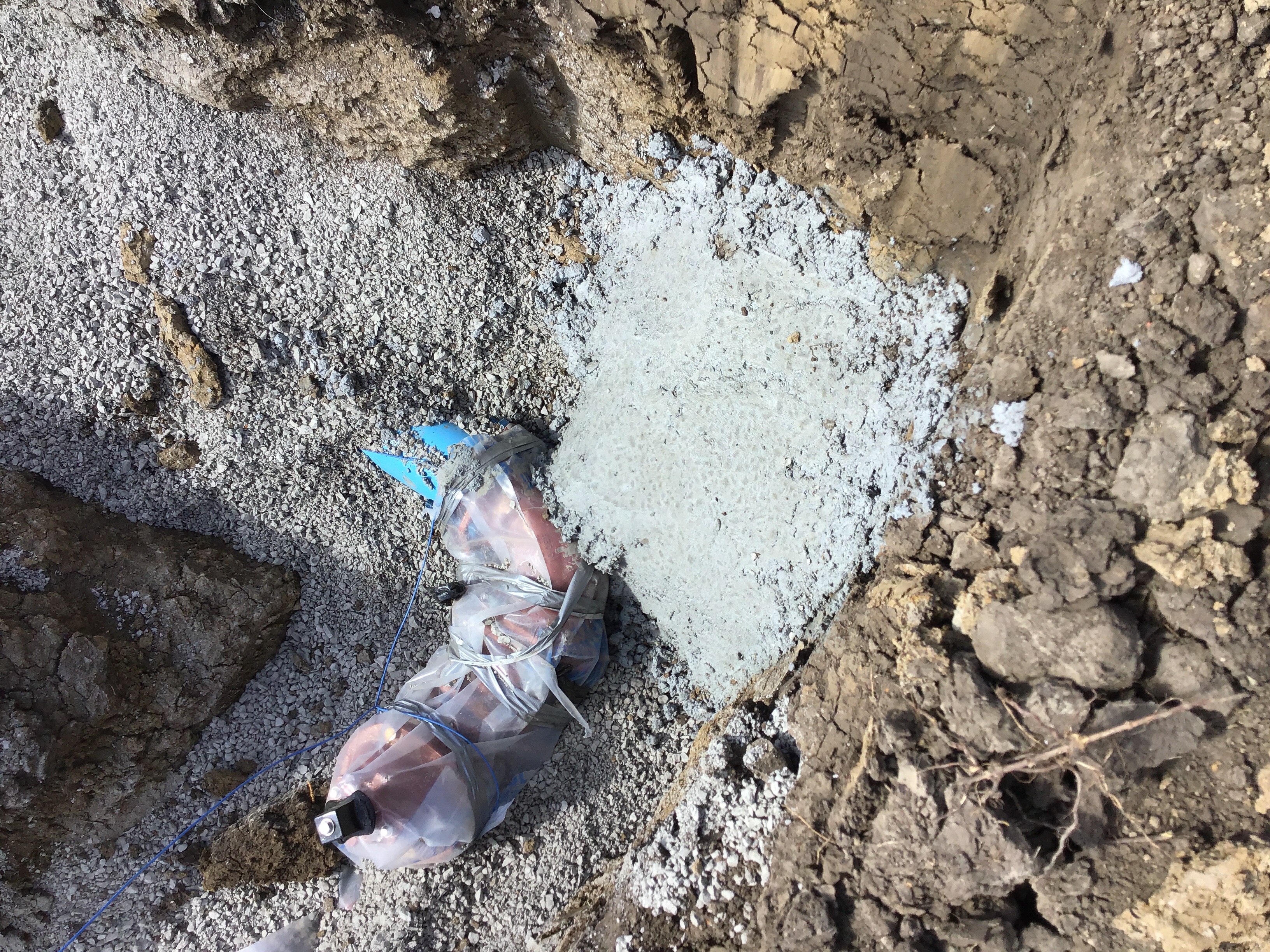

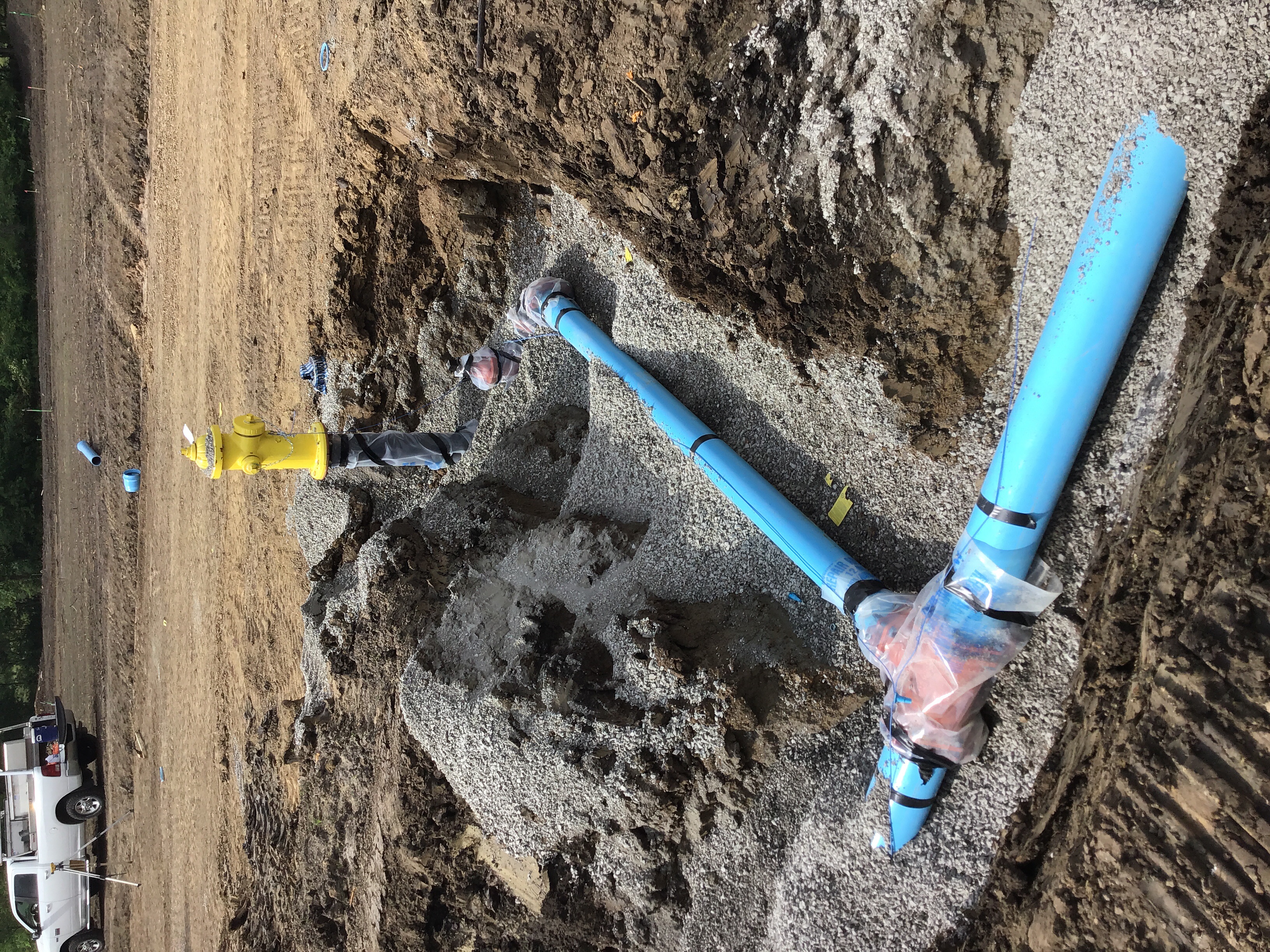

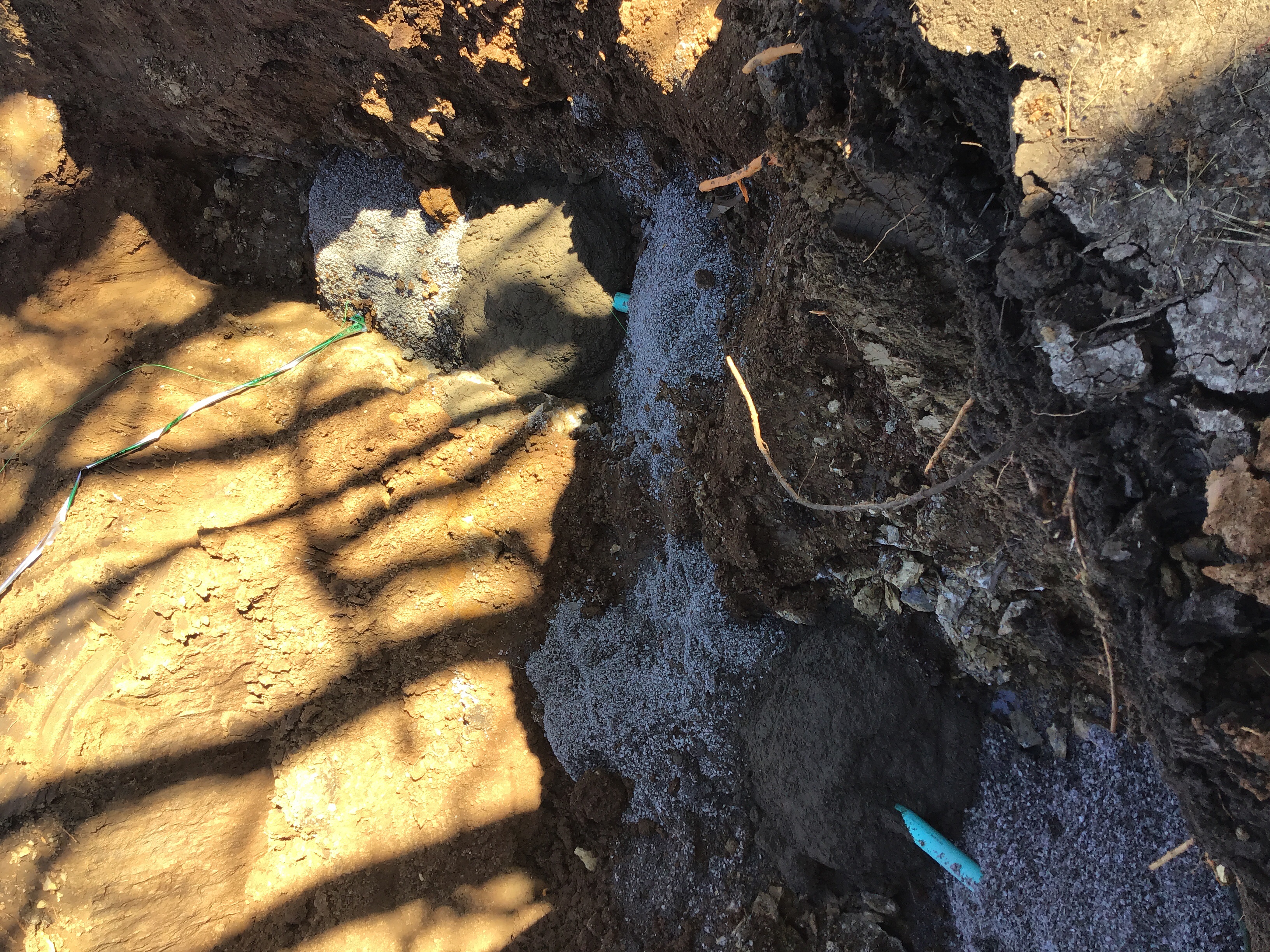

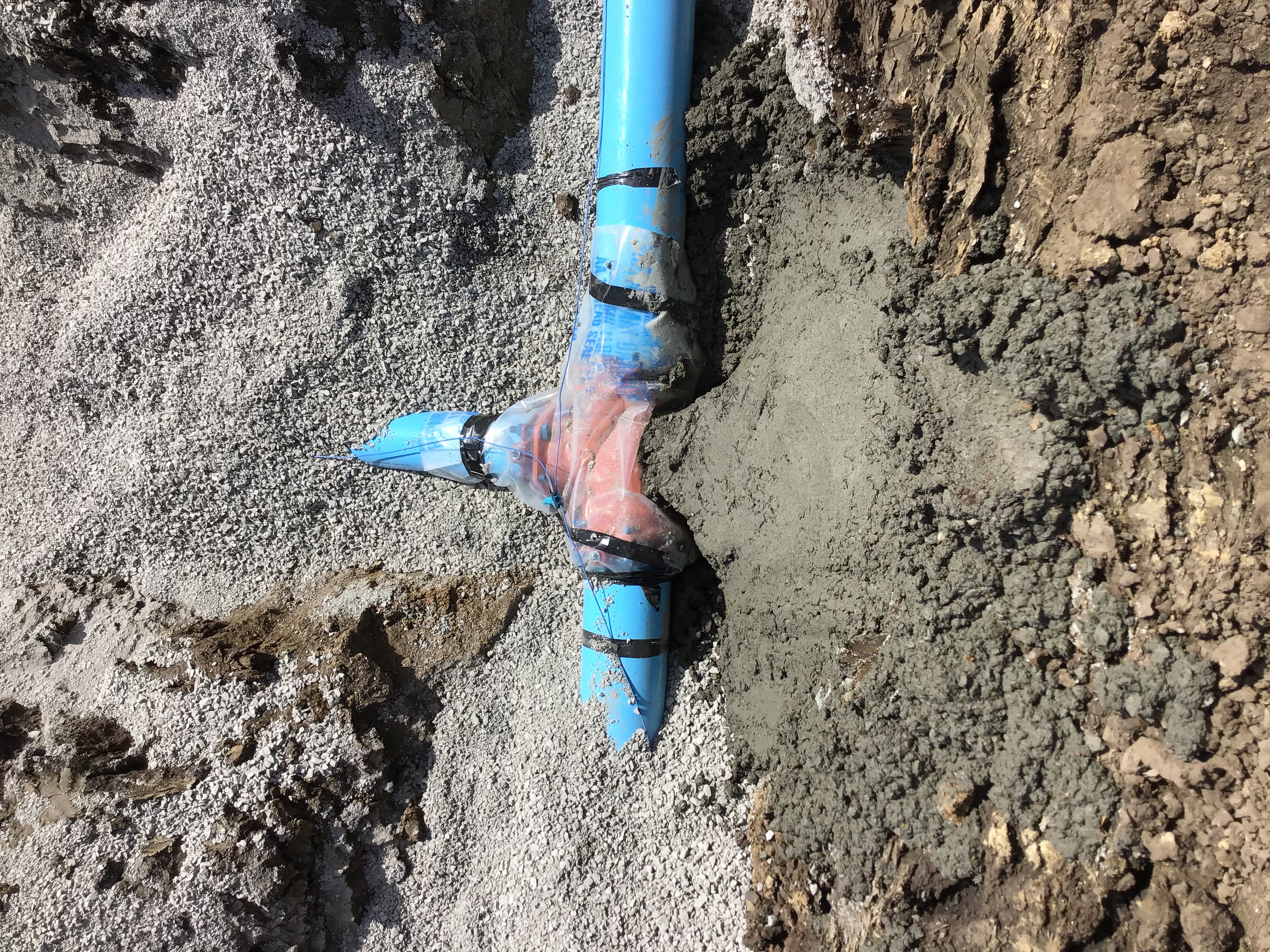

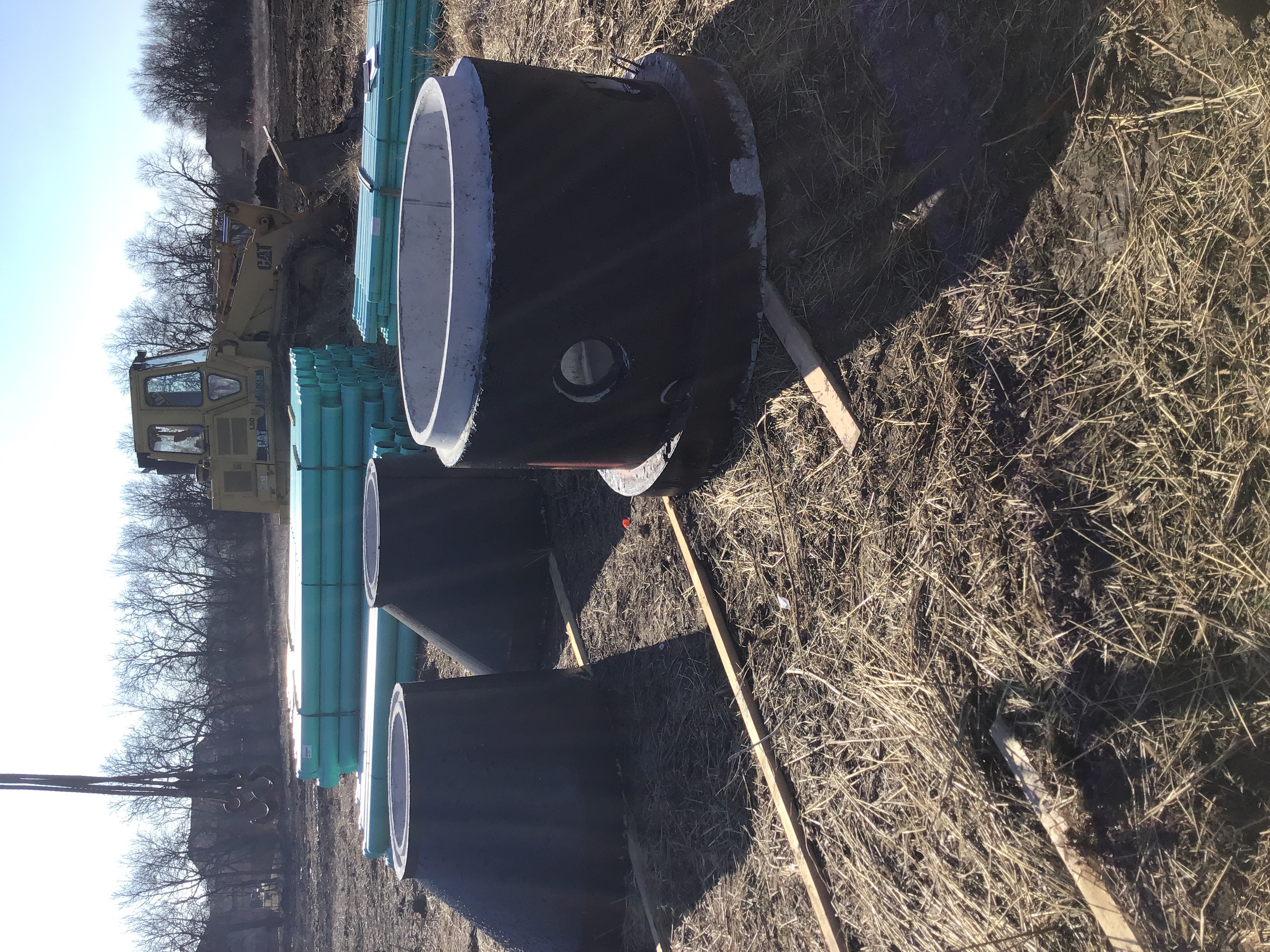

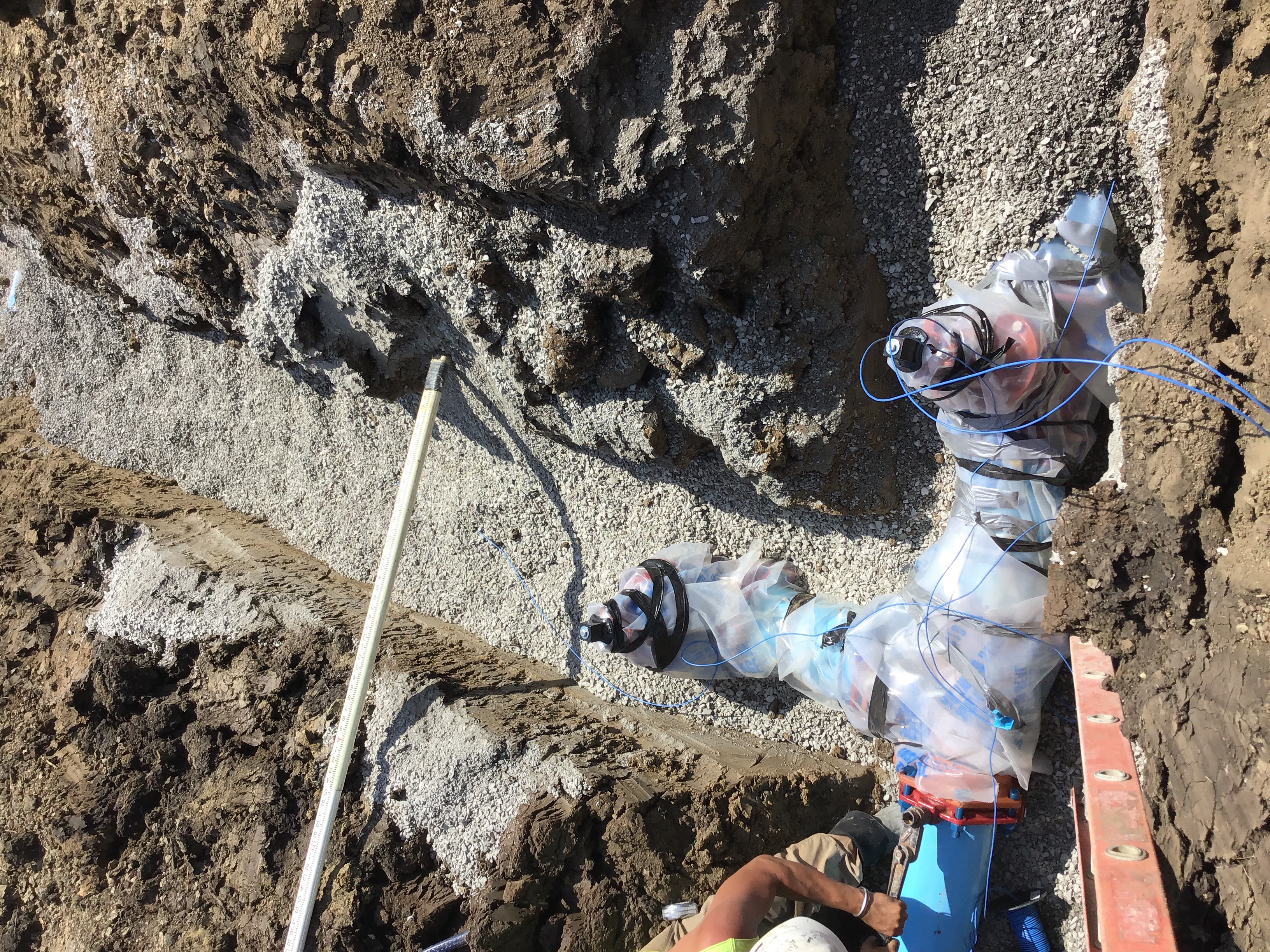

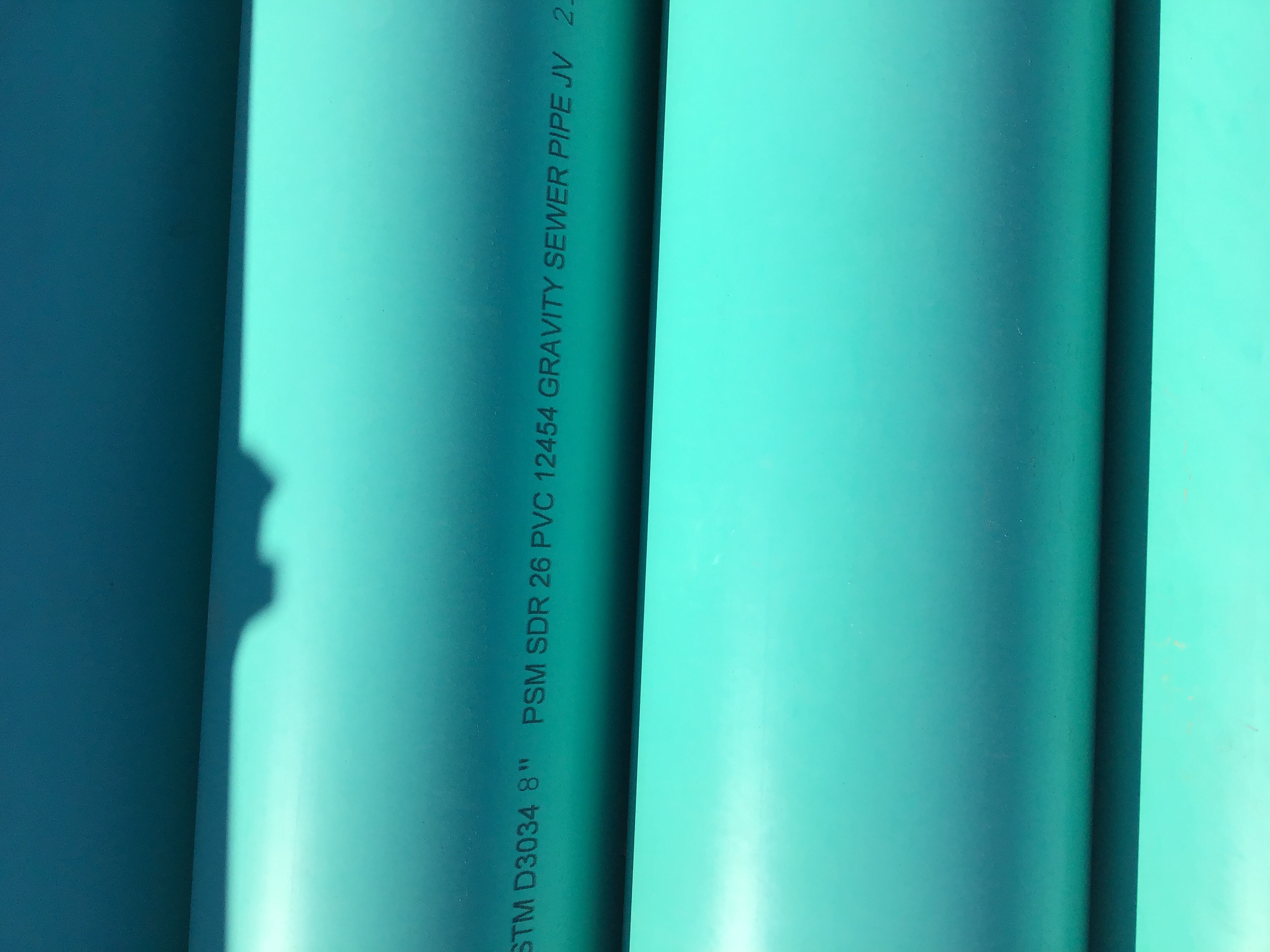

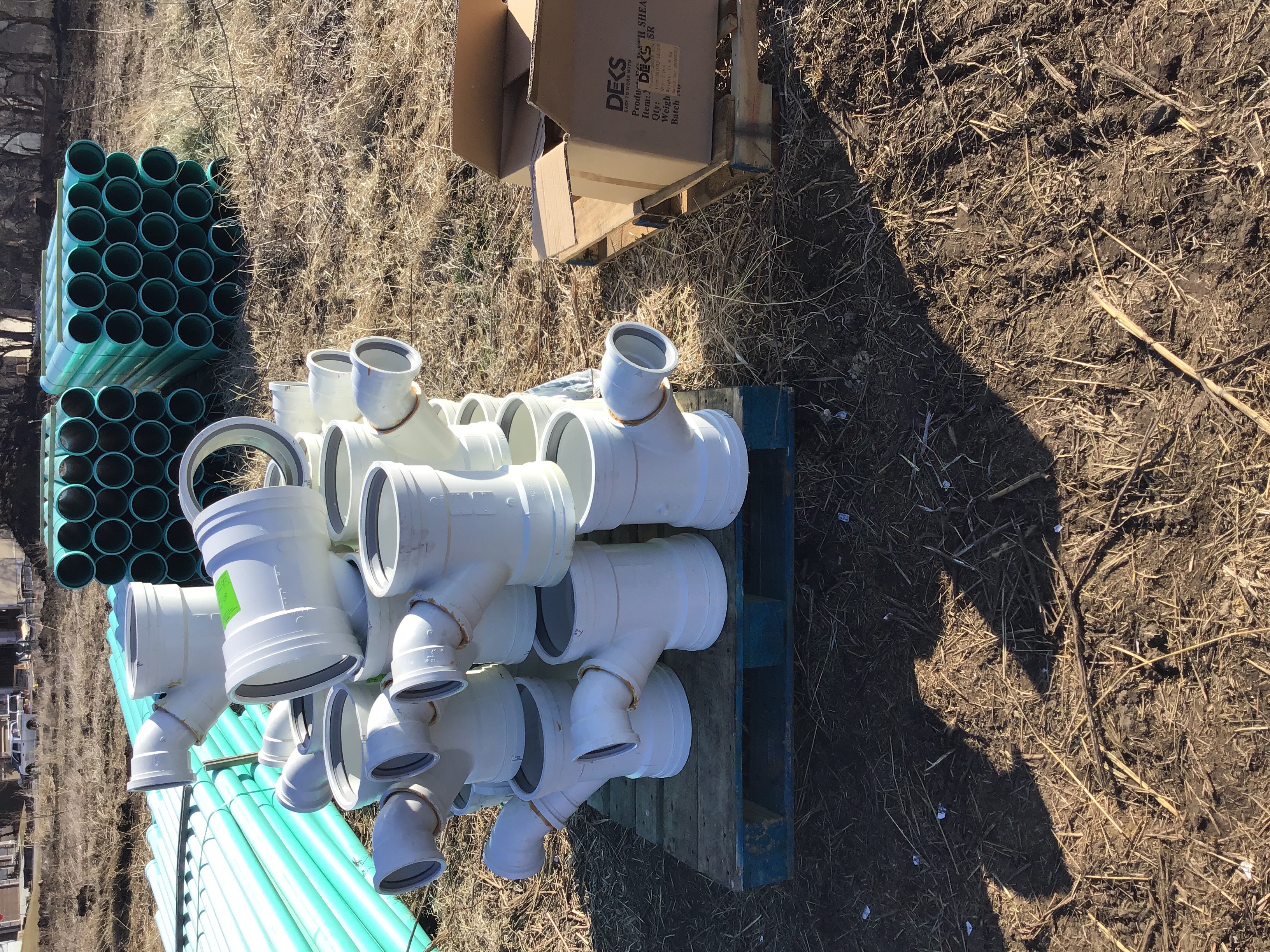

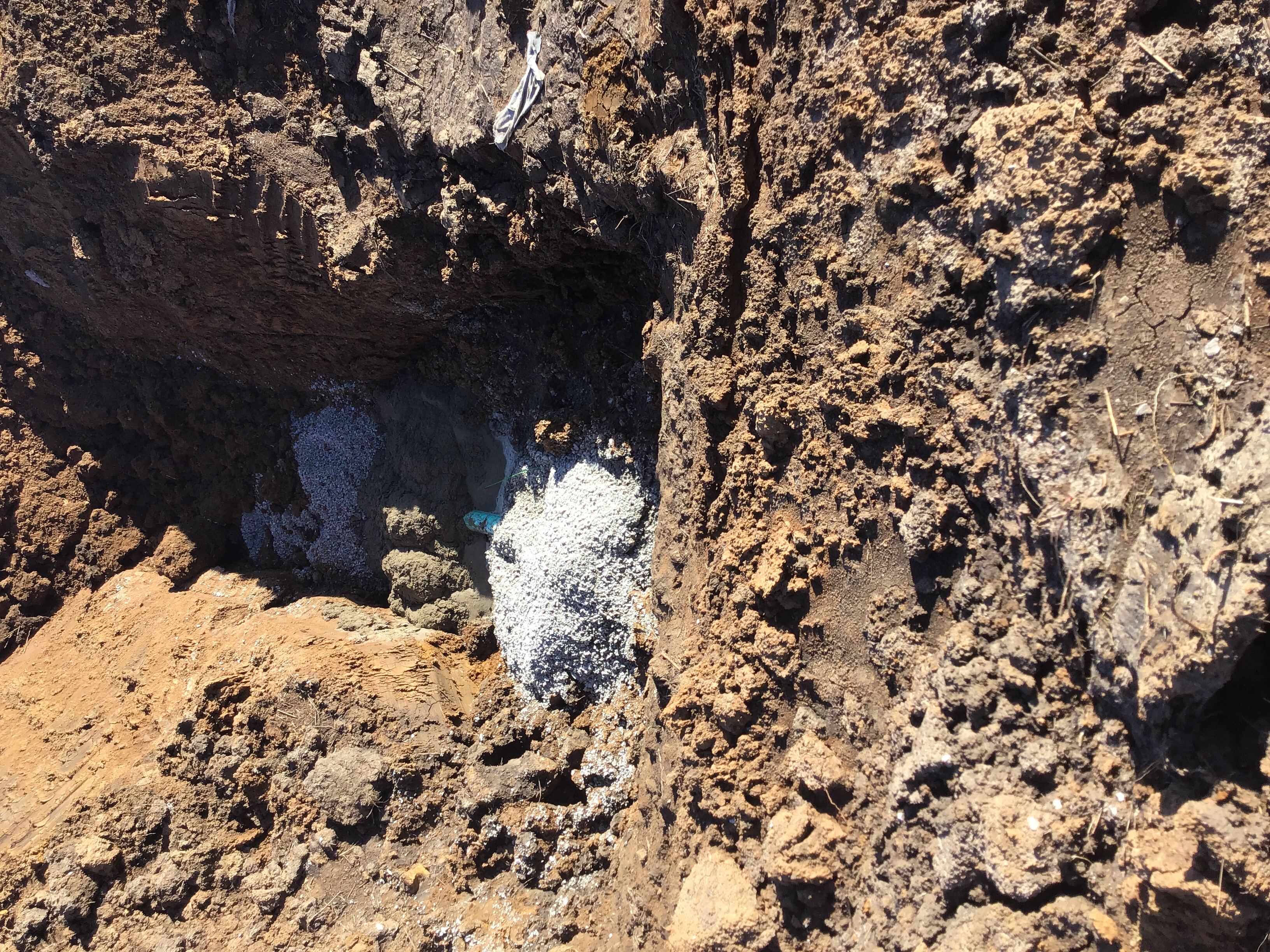

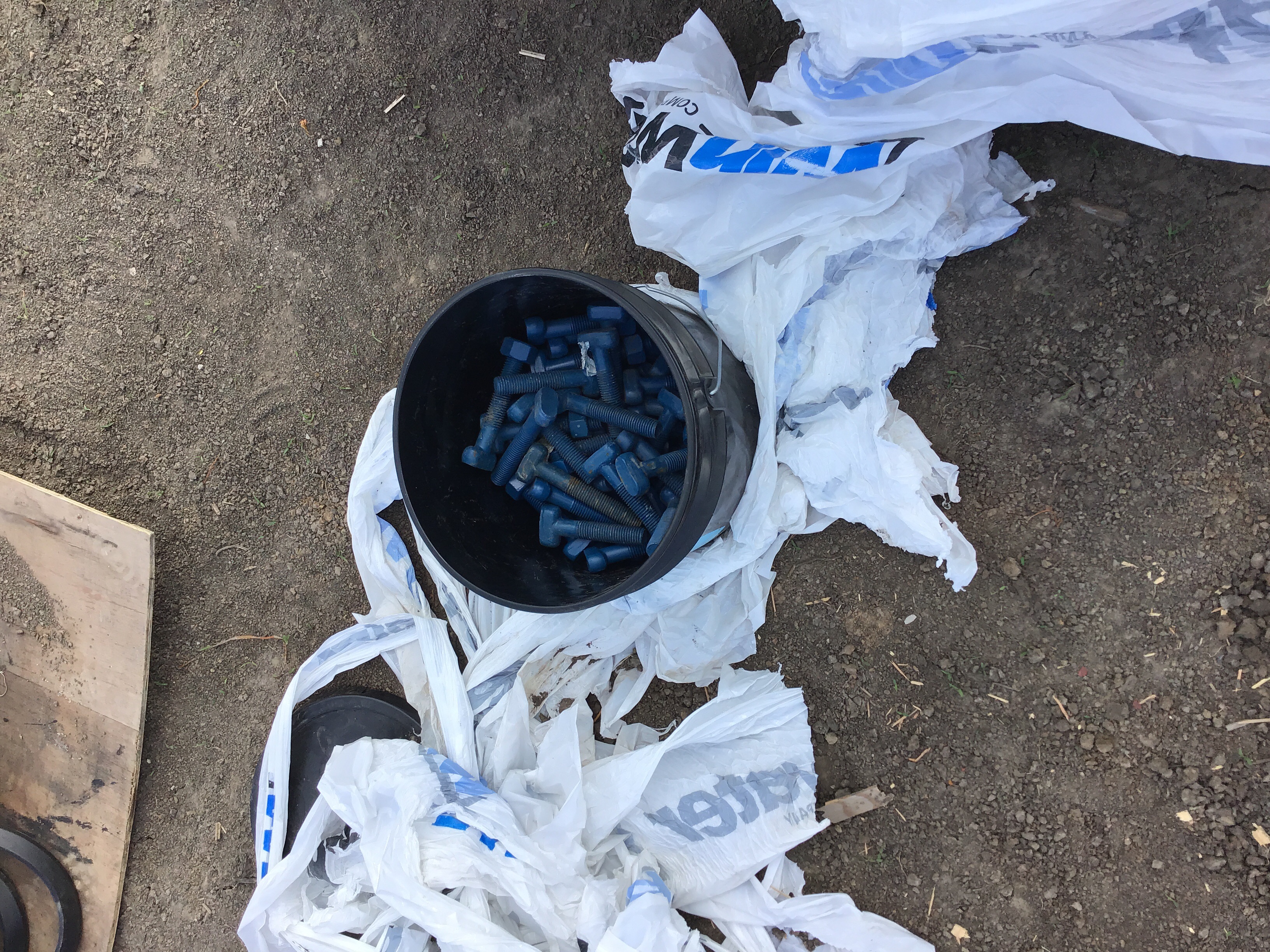

Sanitary - Material Verification Passed 3/18/2019 03/18/2019
Misc
Informational
03/18/2019

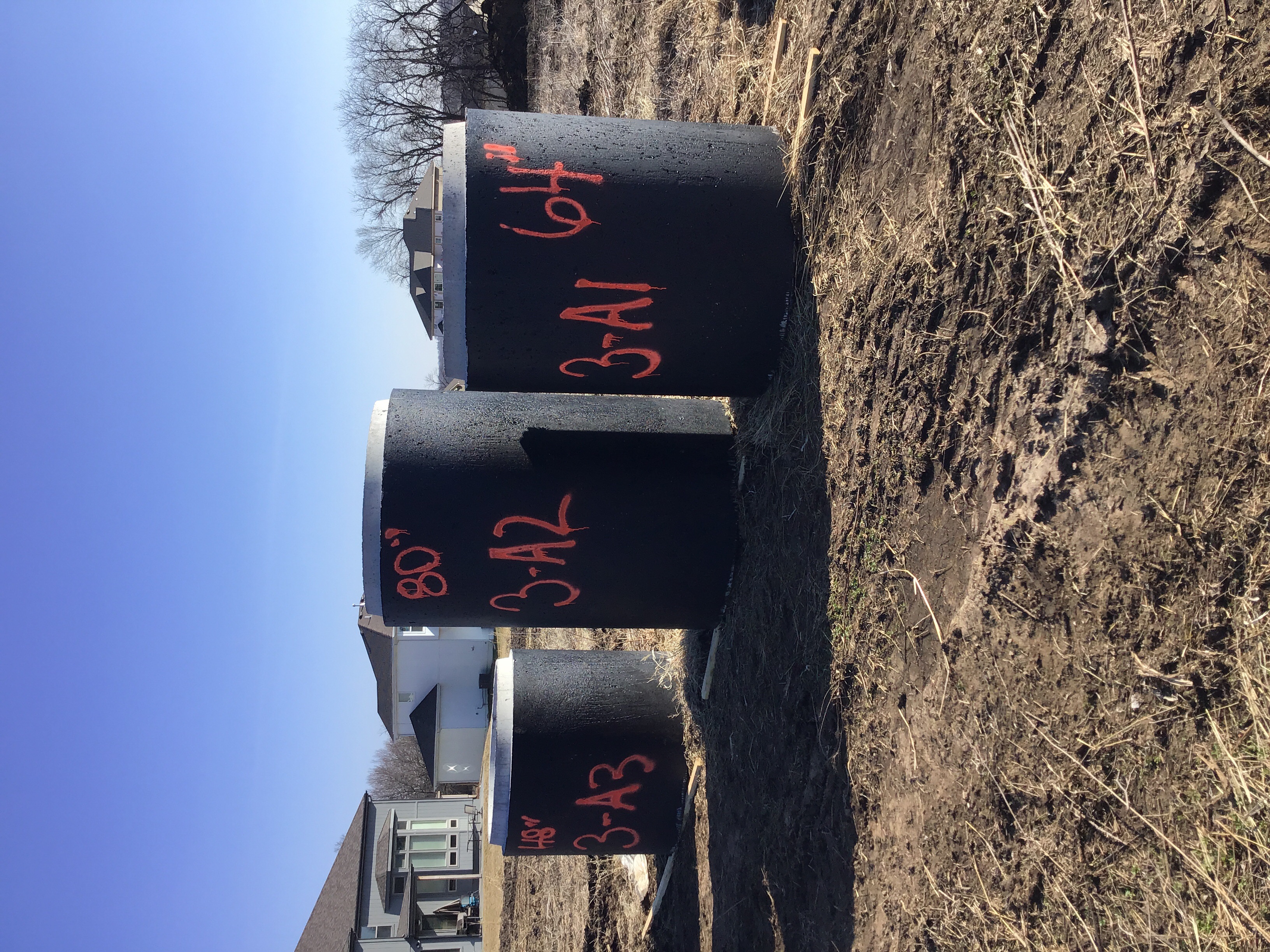

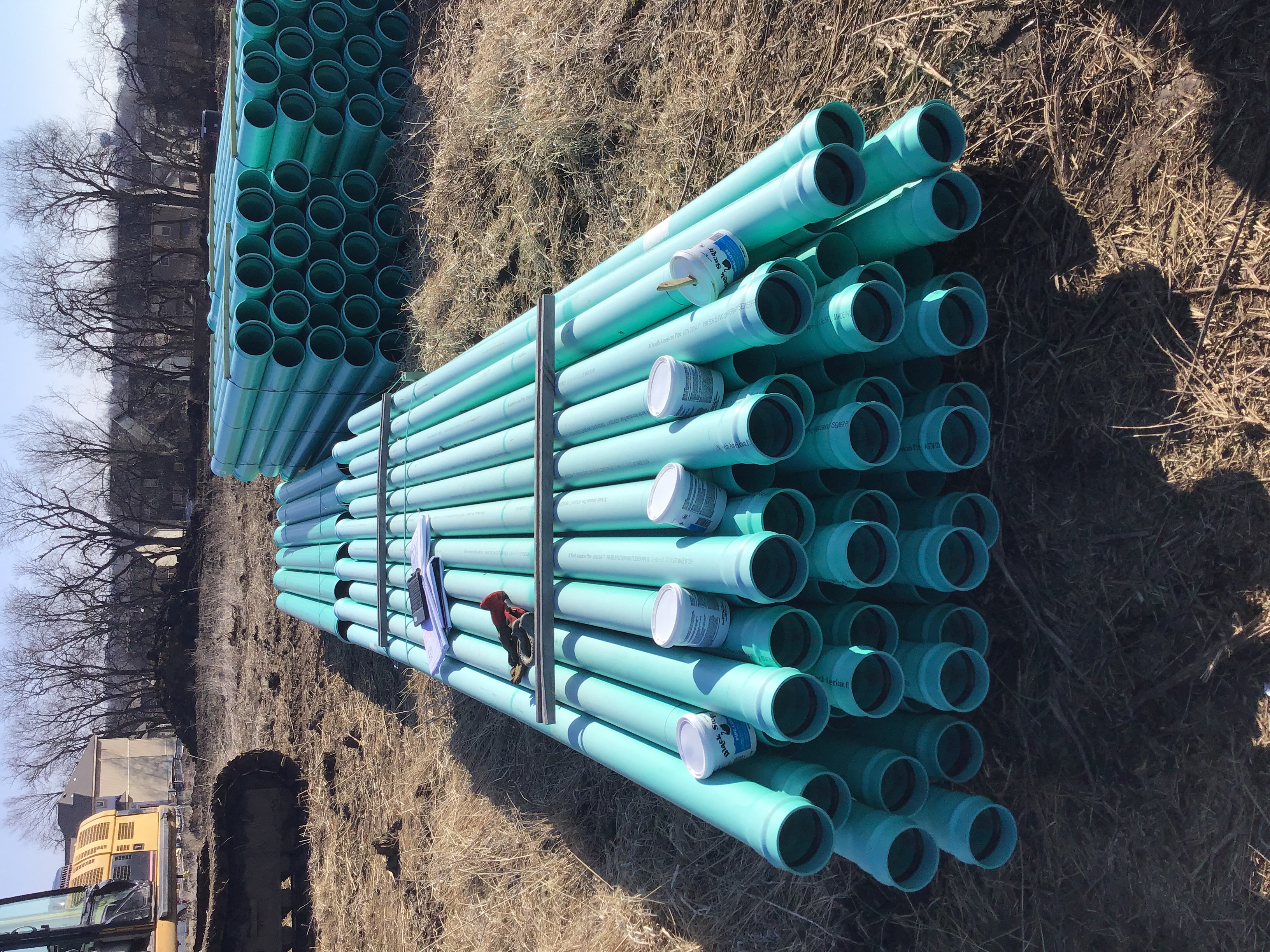

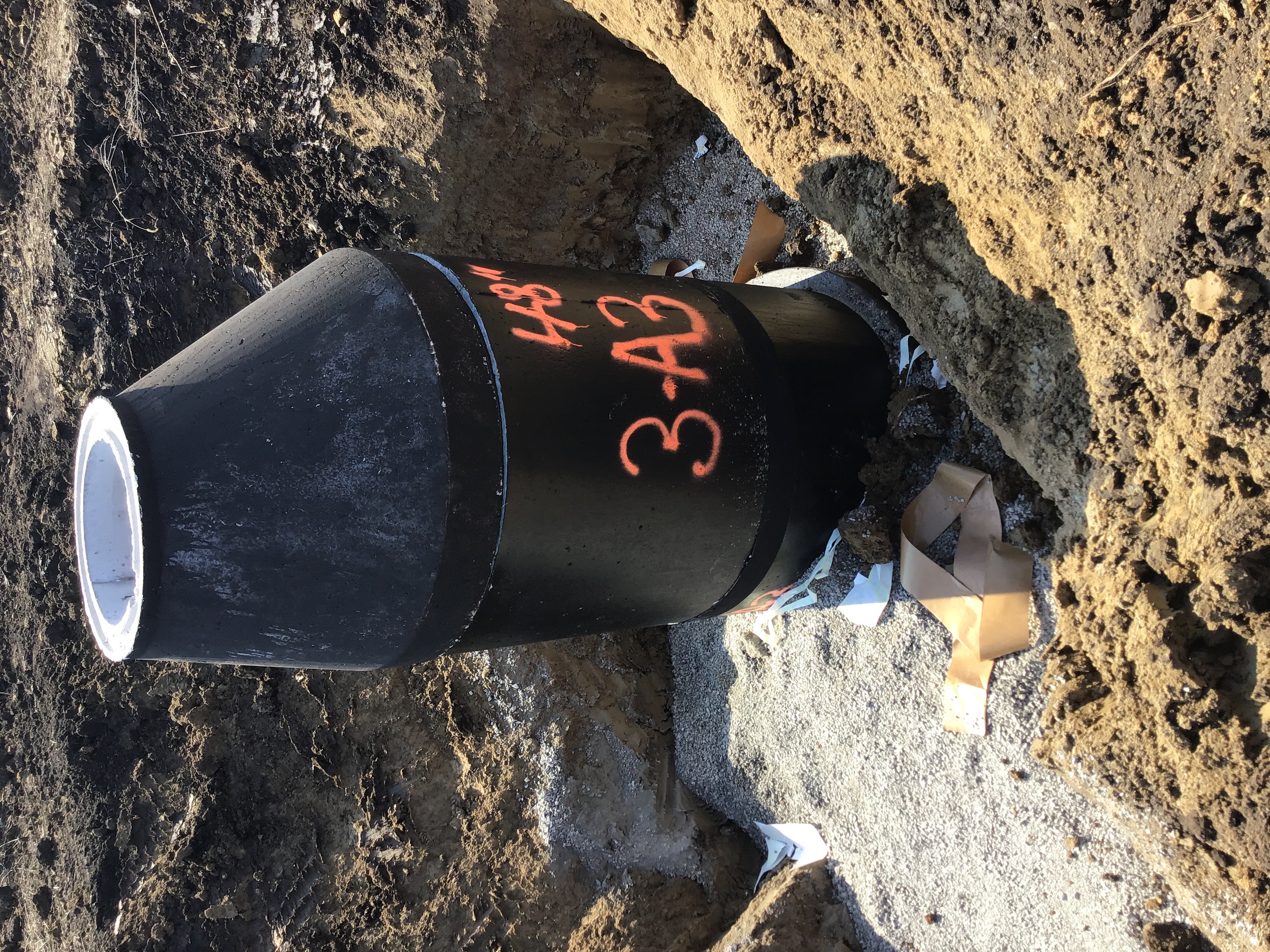

I verified that the materials on site for sanitary sewer lines 3-A & 3-B match the approved plans and meet the City of Lee’s Summit standard specifications. Photos are attached.

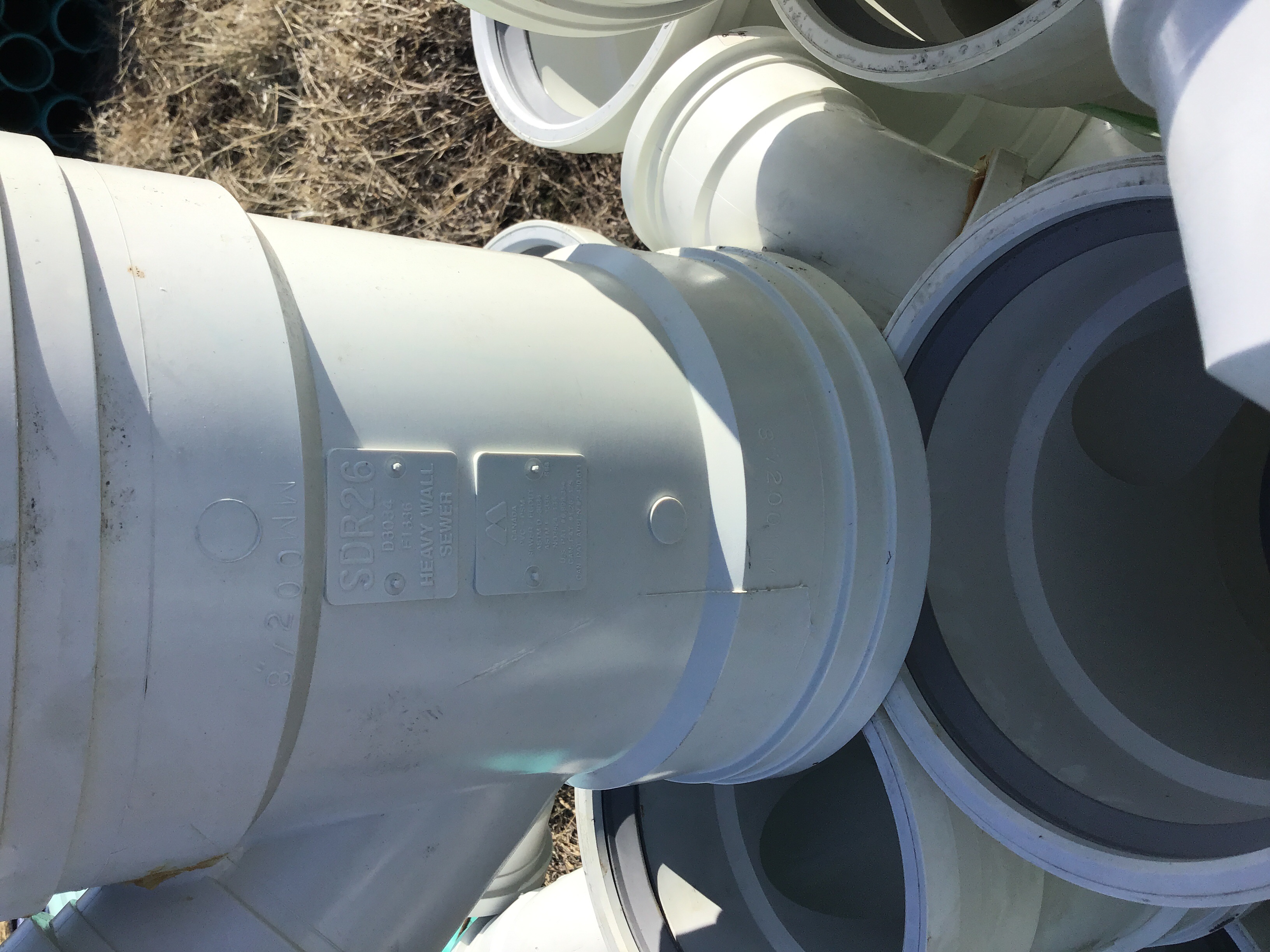

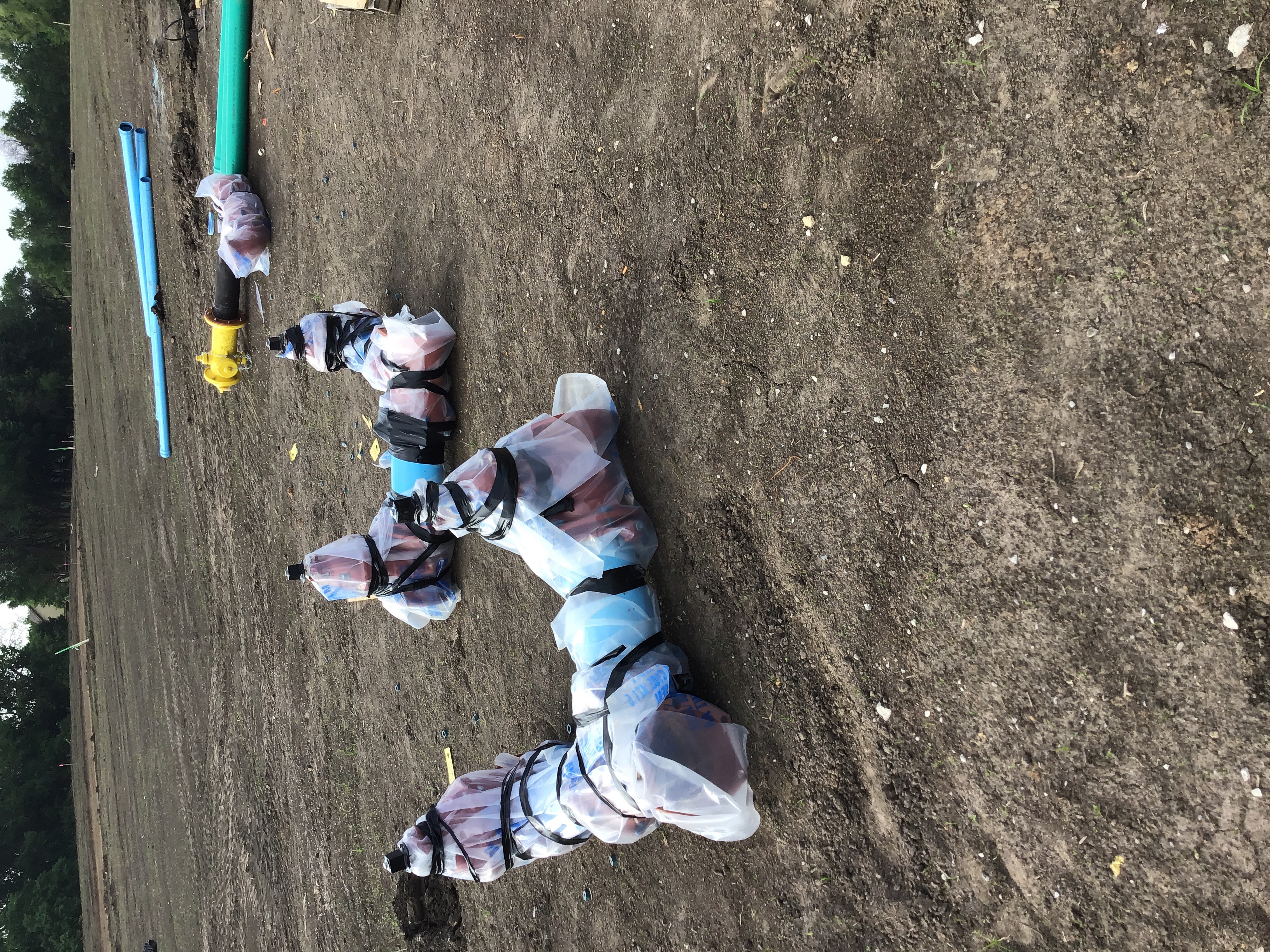

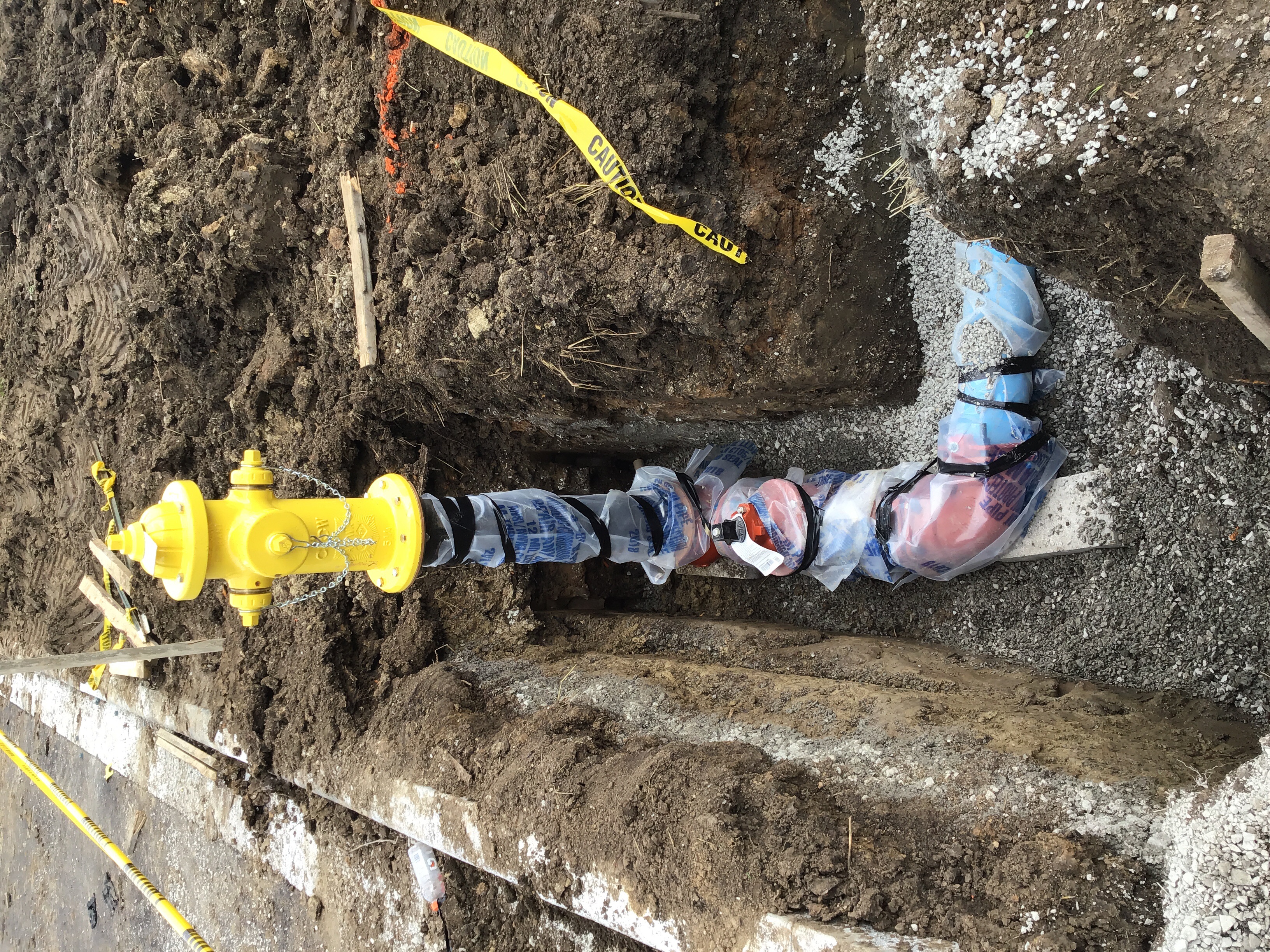

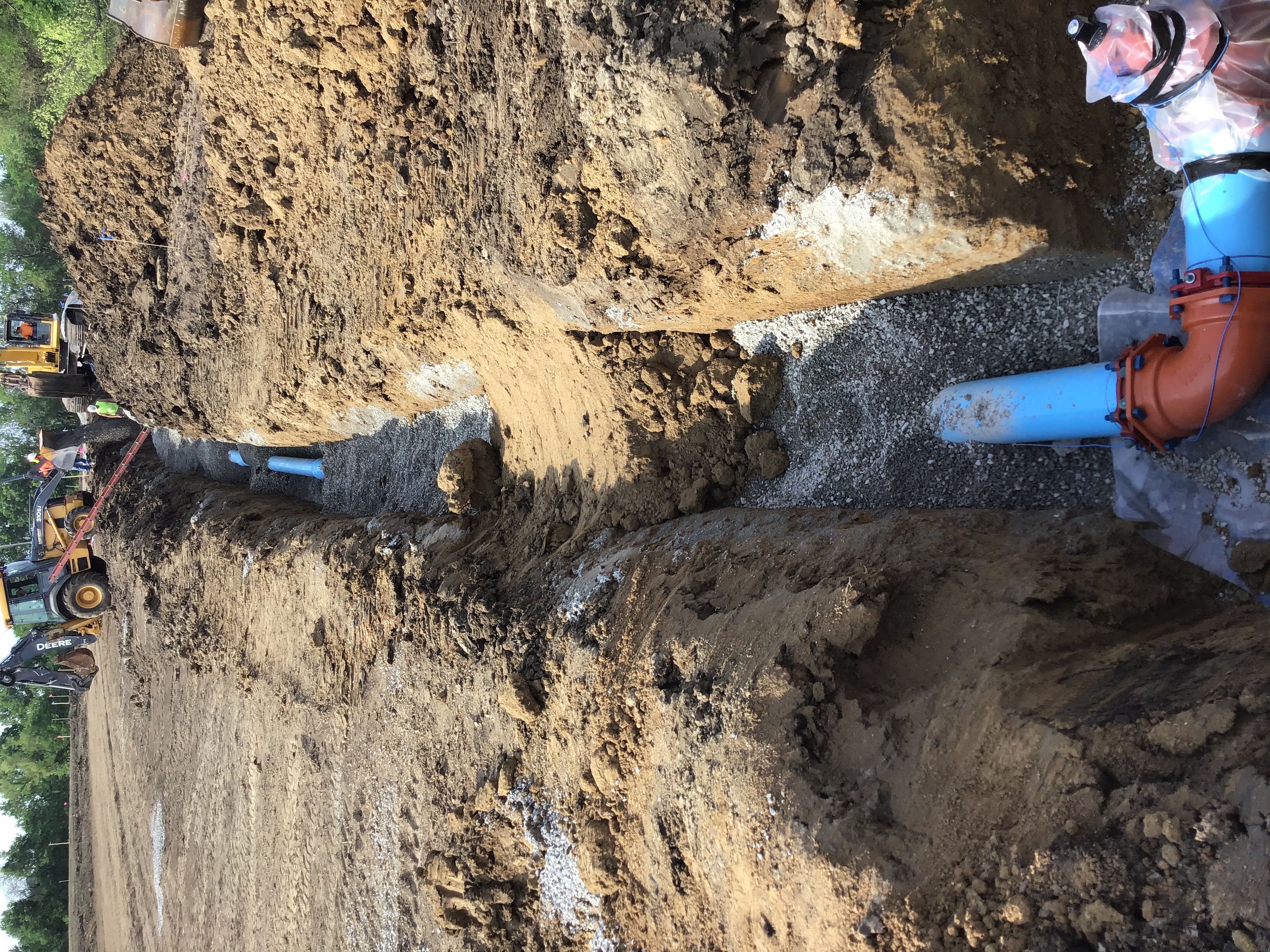

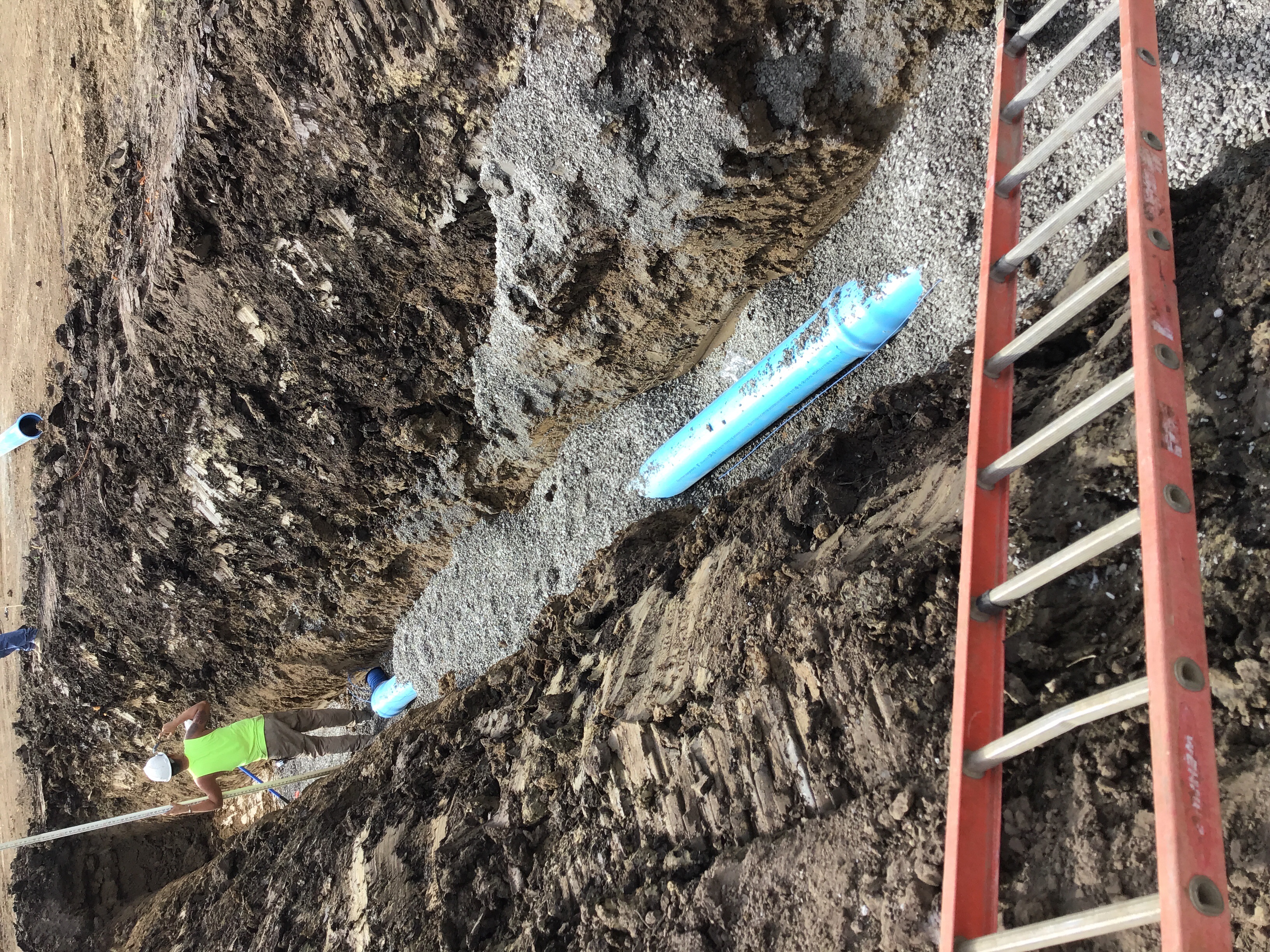

Sanitary Sewer Construction Inspection Partial 3/18/2019 03/18/2019
Misc
Informational
03/18/2019

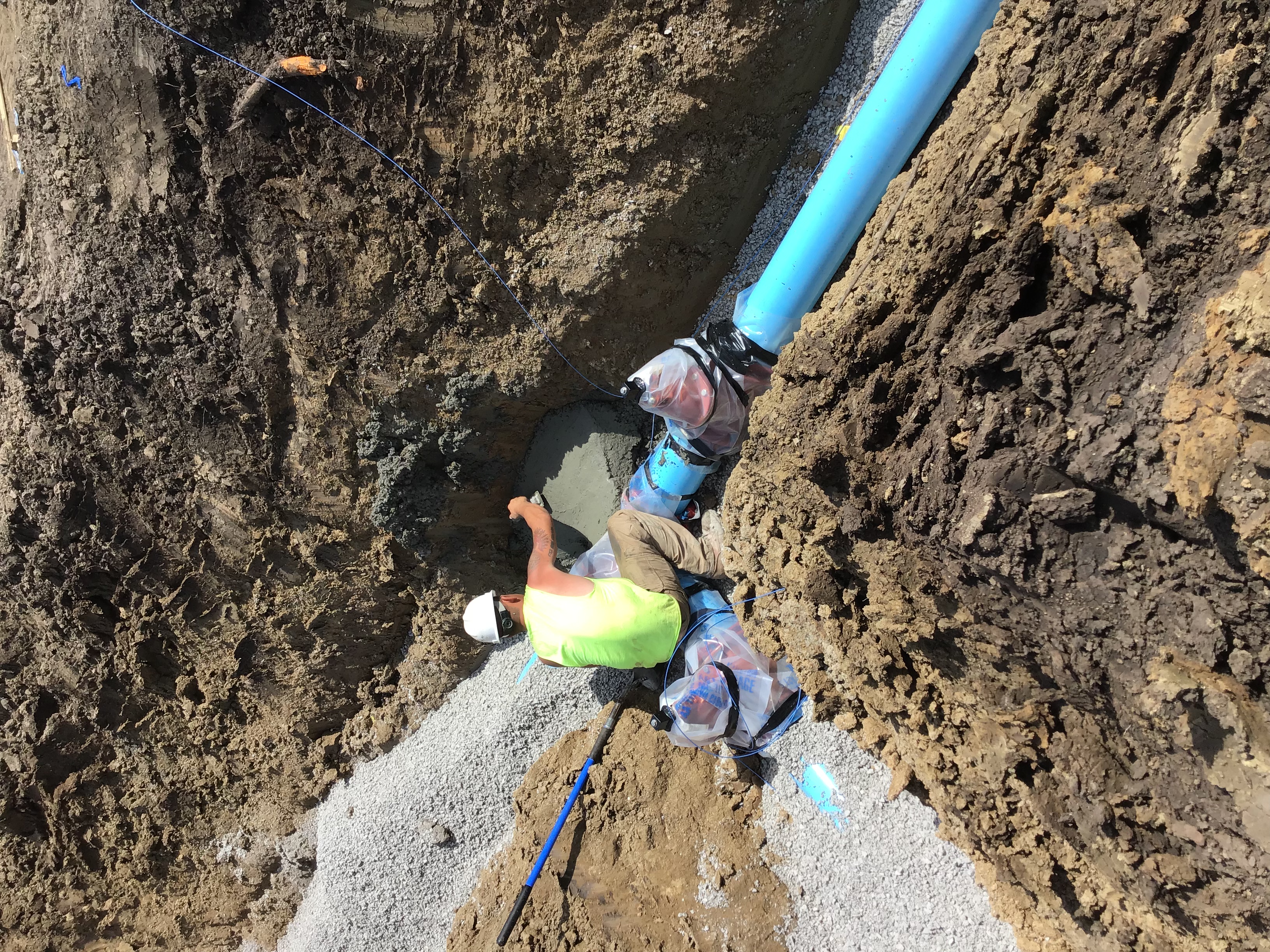

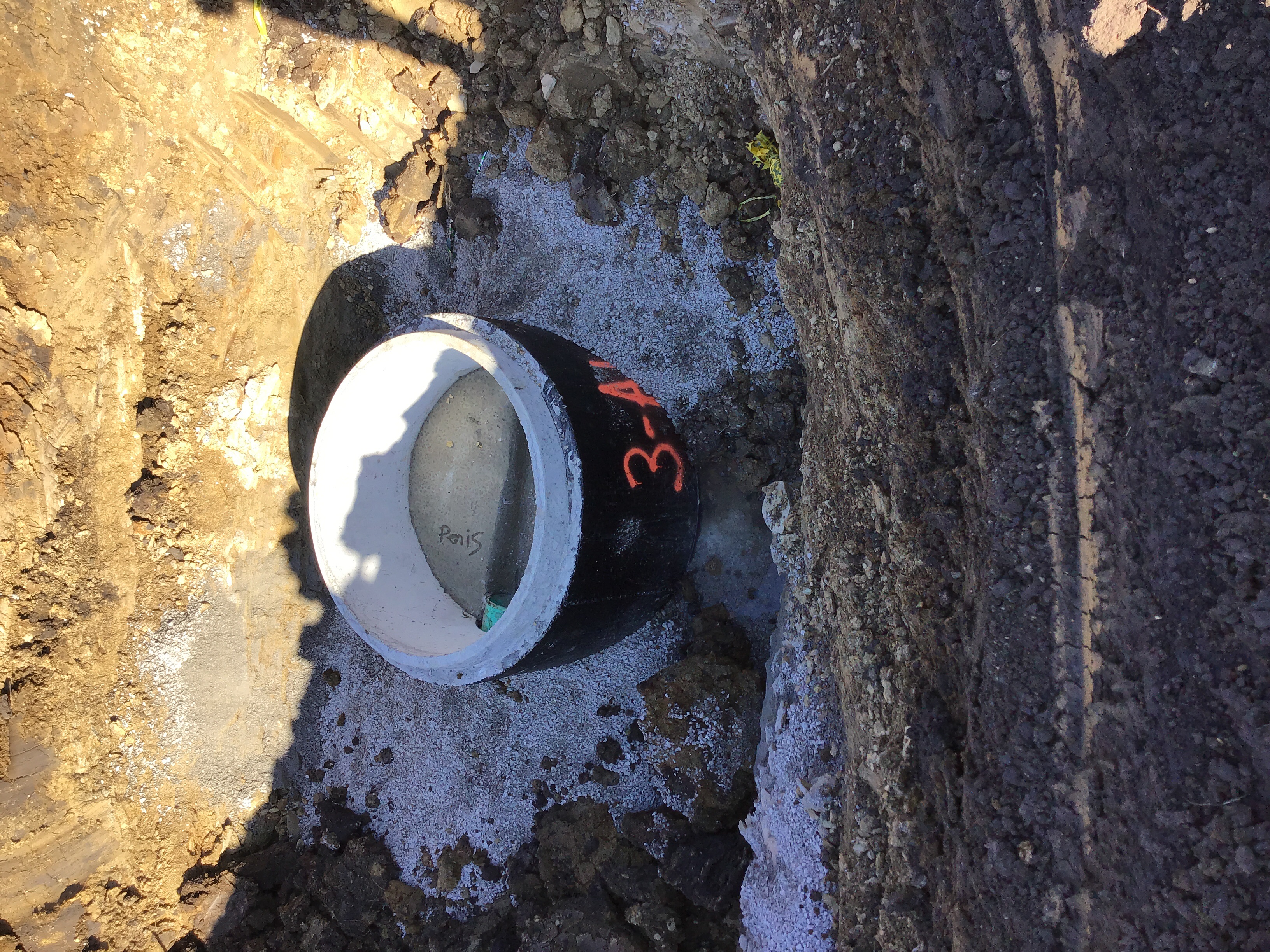

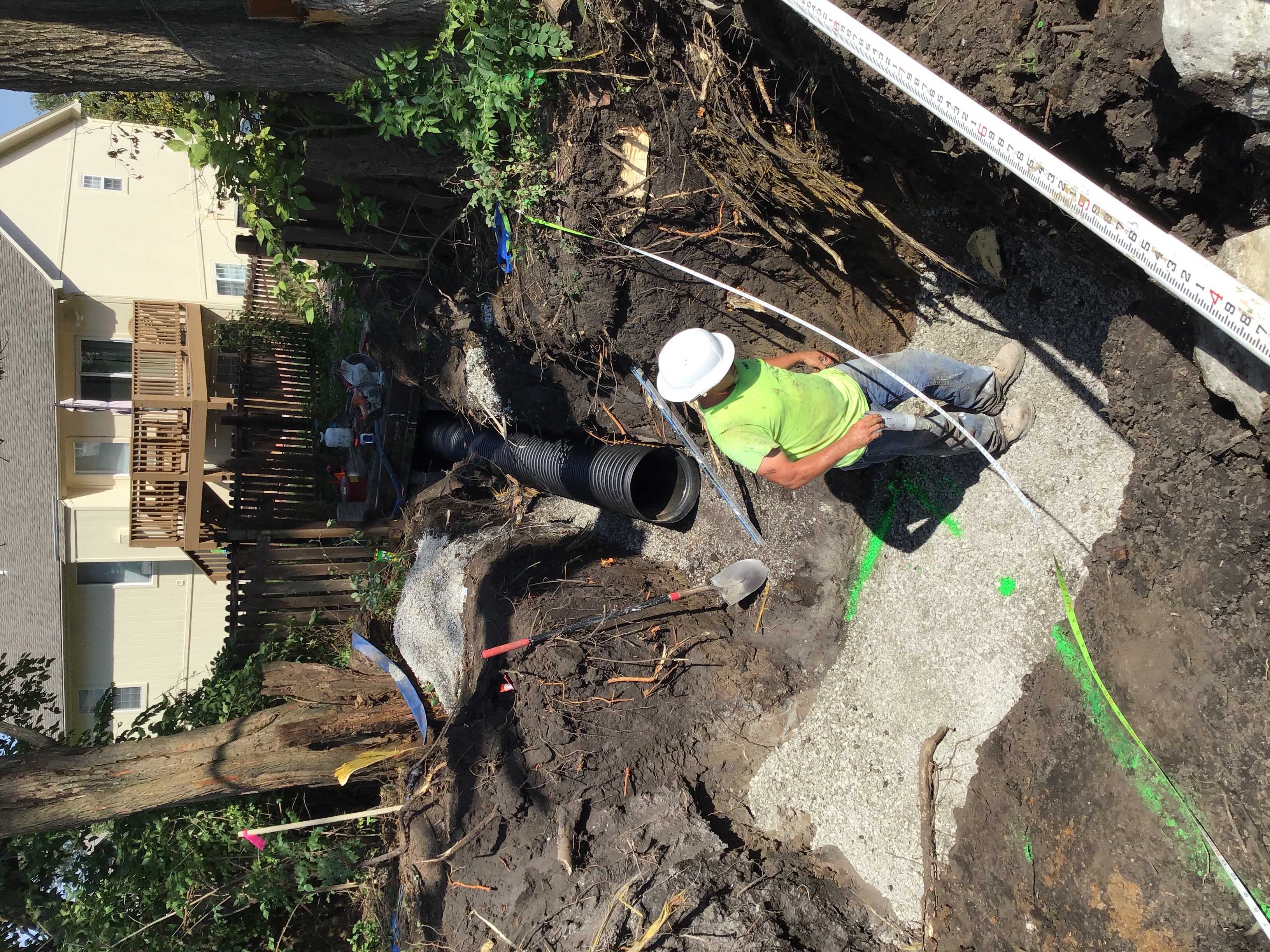

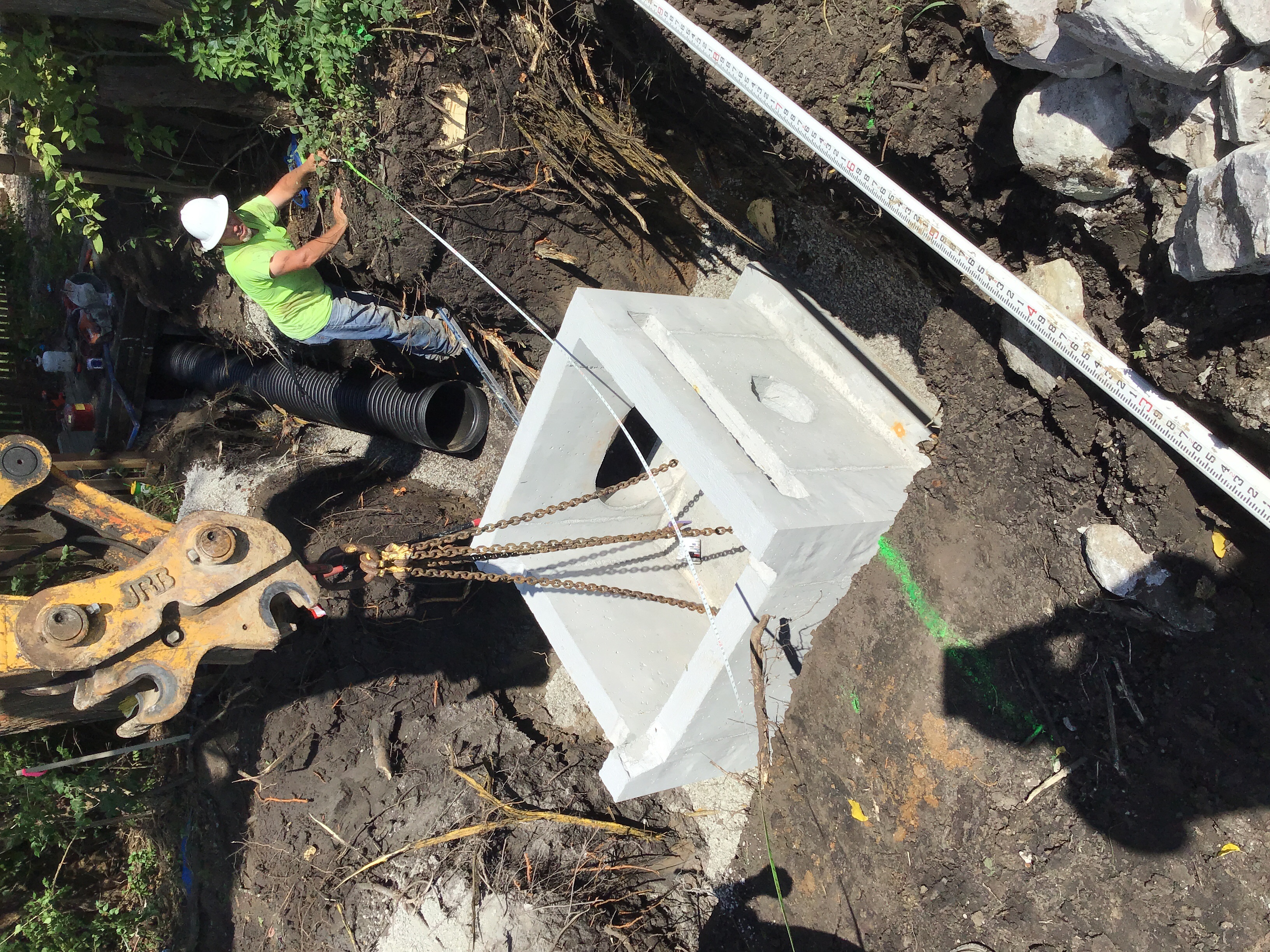

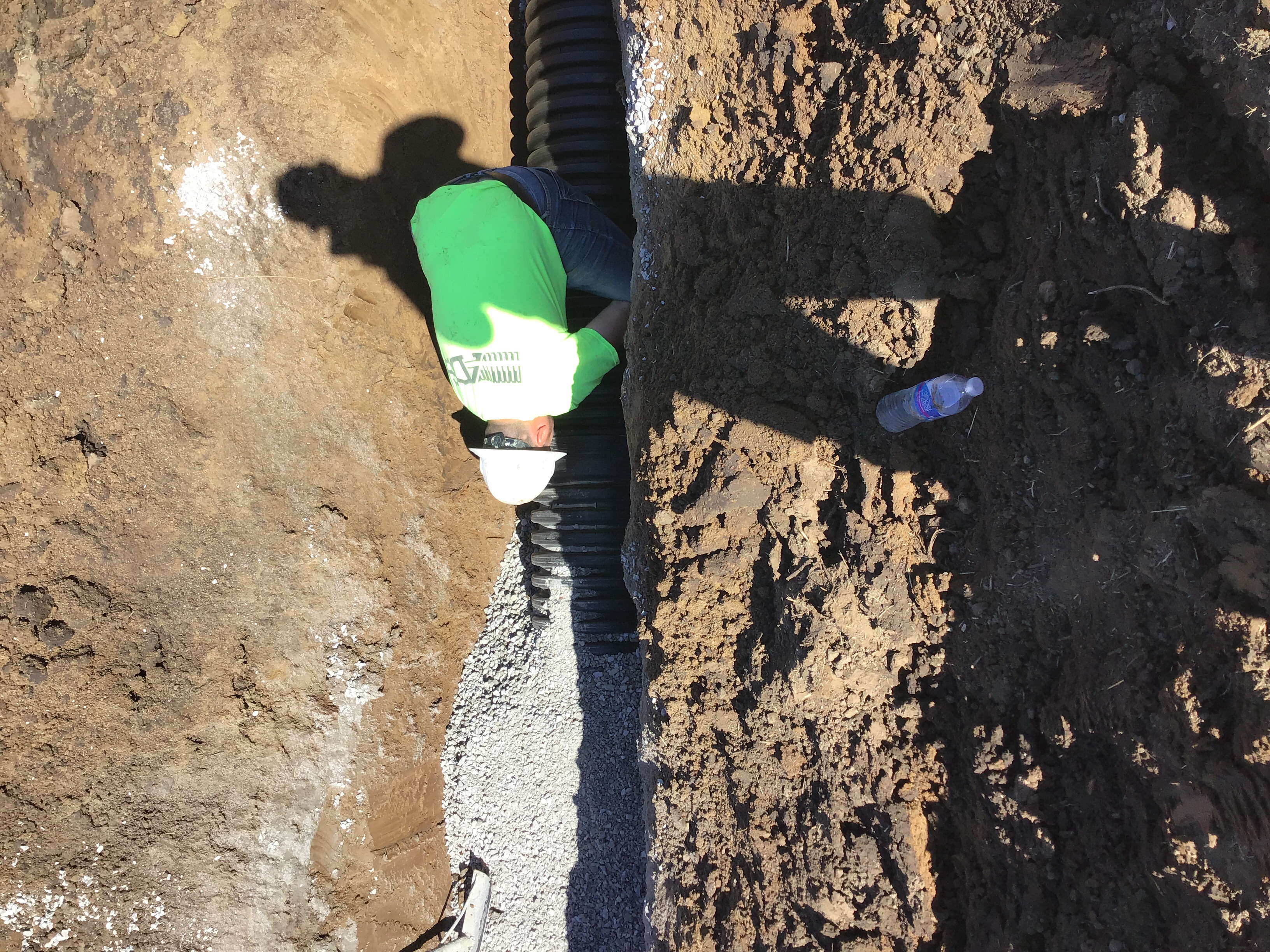

The Redford Construction crew is on site starting the sanitary sewer install. The crew is currently core drilling into the existing city MH 55-106. The crew plans to continue the install of line 3-A once they have finished the core. I will return for further inspection this afternoon.
Sanitary Sewer Construction Inspection Partial 03/18/2019
Misc
Informational
03/18/2019

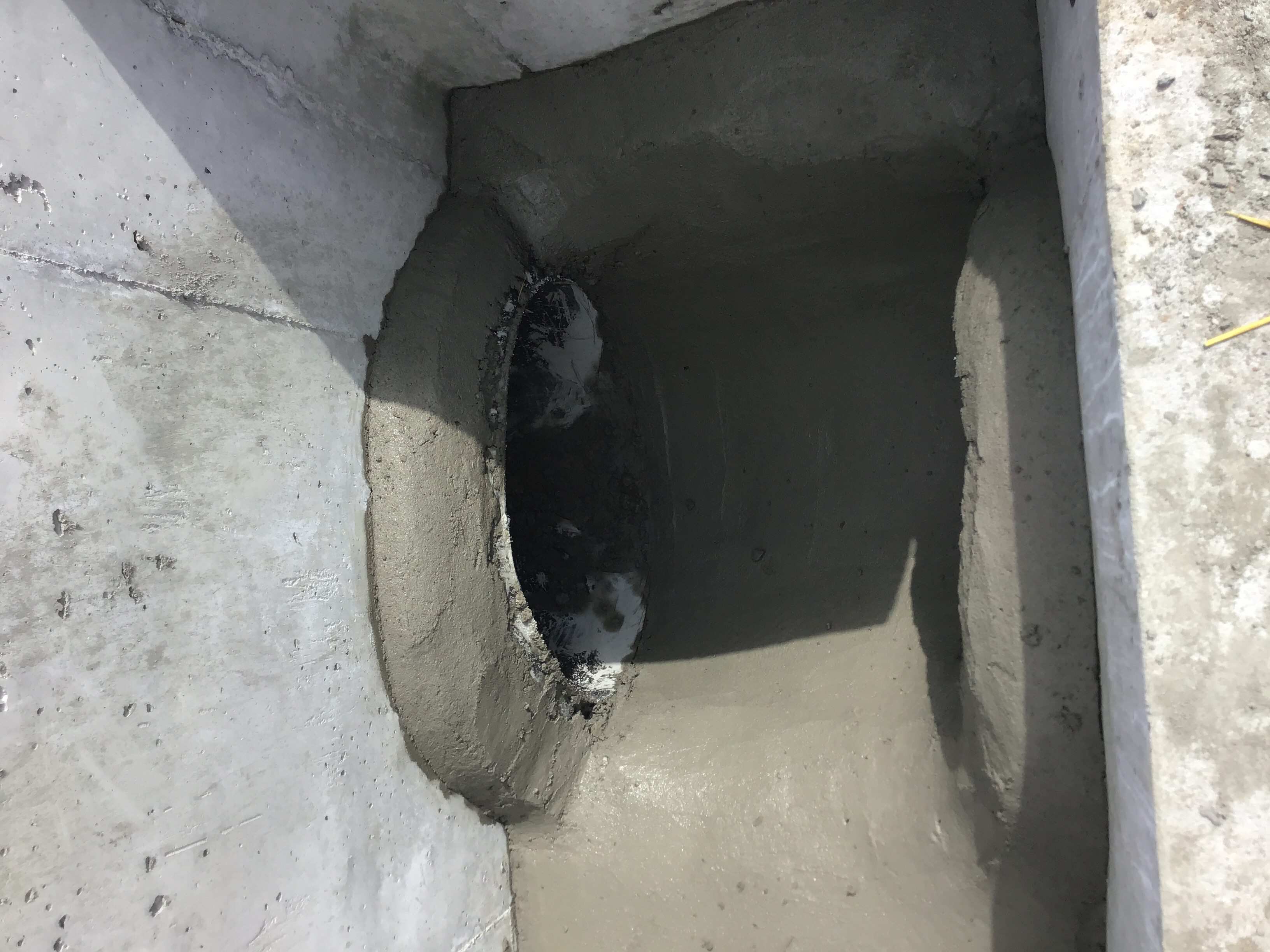

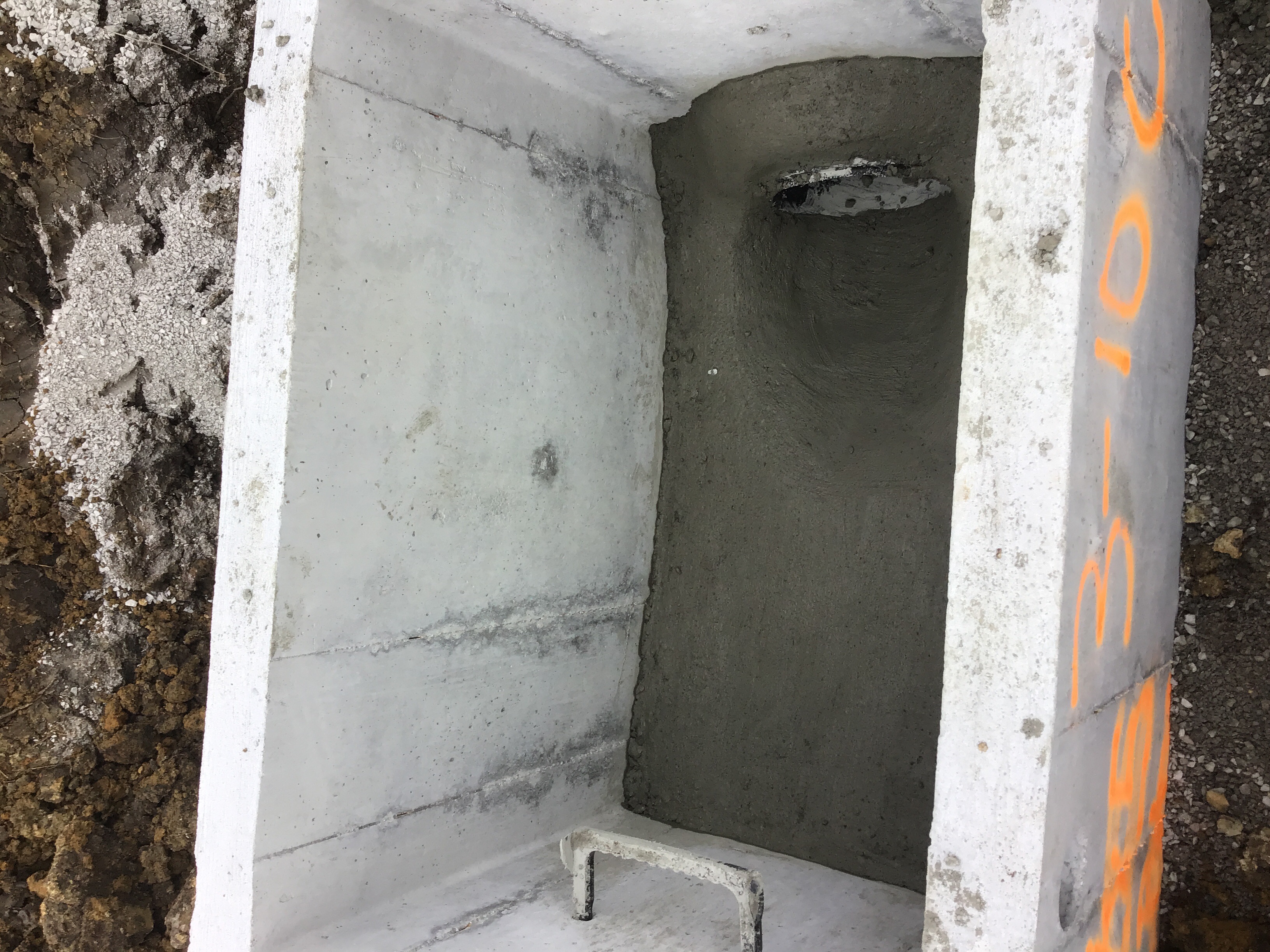

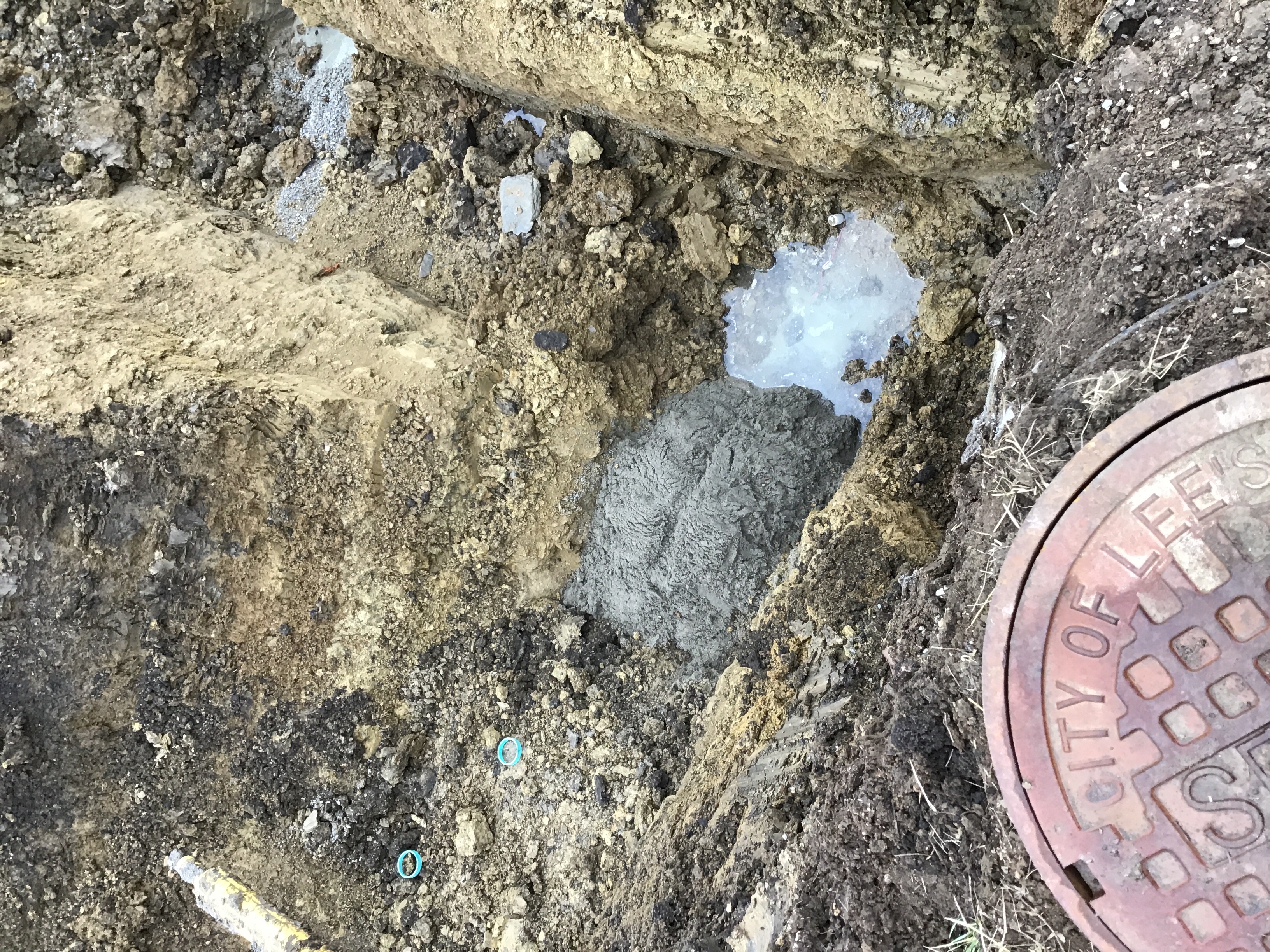

The Redford crew cored into the existing MH 55-106 and installed the pipe for line 3-A. They will install the invert at a later date. The crew is continuing the install for the line 3-A. There appears to be sufficient aggregate surrounding the pipe. The wye fittings for the service laterials appear to be set at the correct angle.
Sanitary Sewer Construction Inspection Partial 03/19/2019
Misc
Informational
03/19/2019

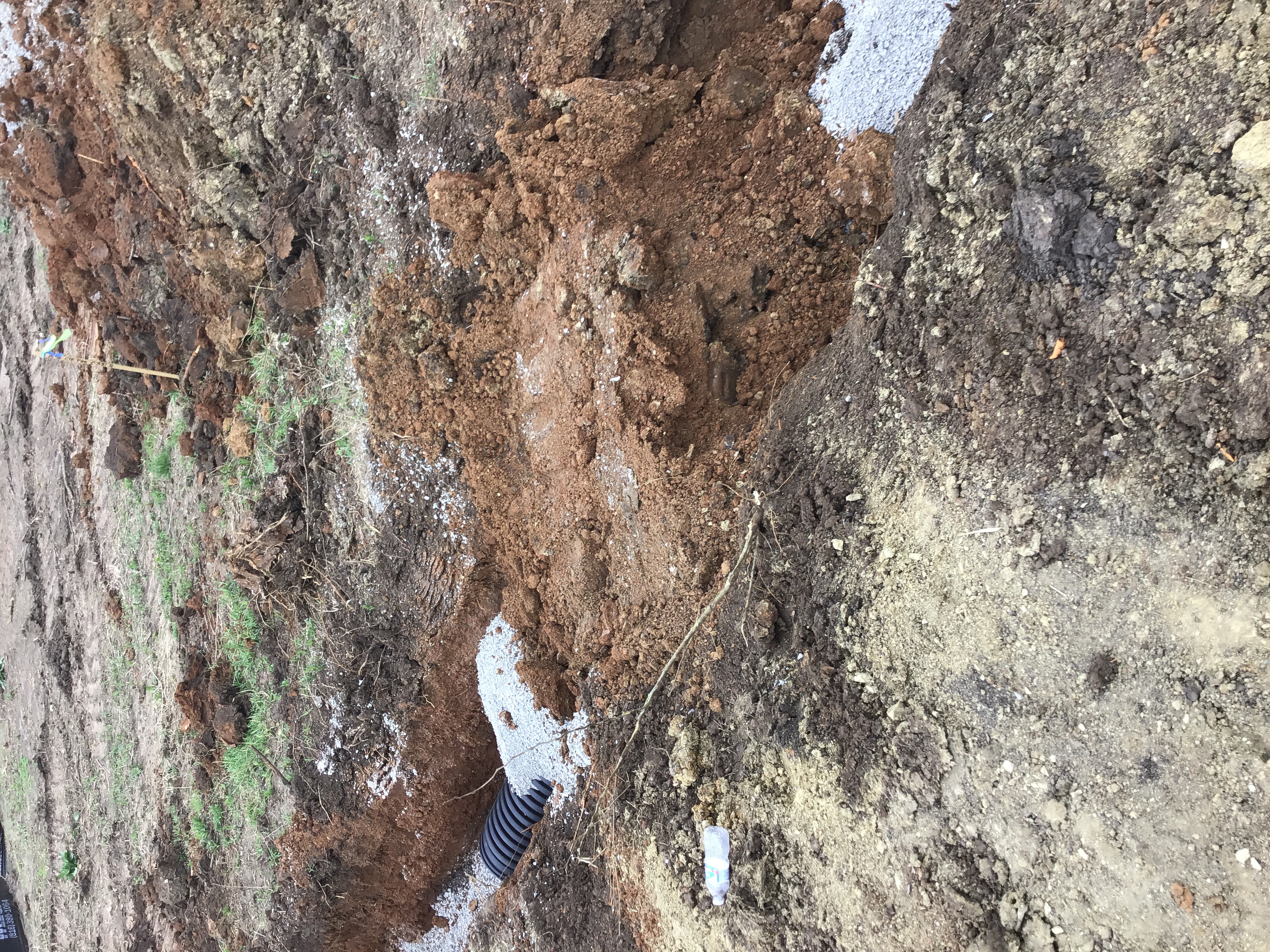

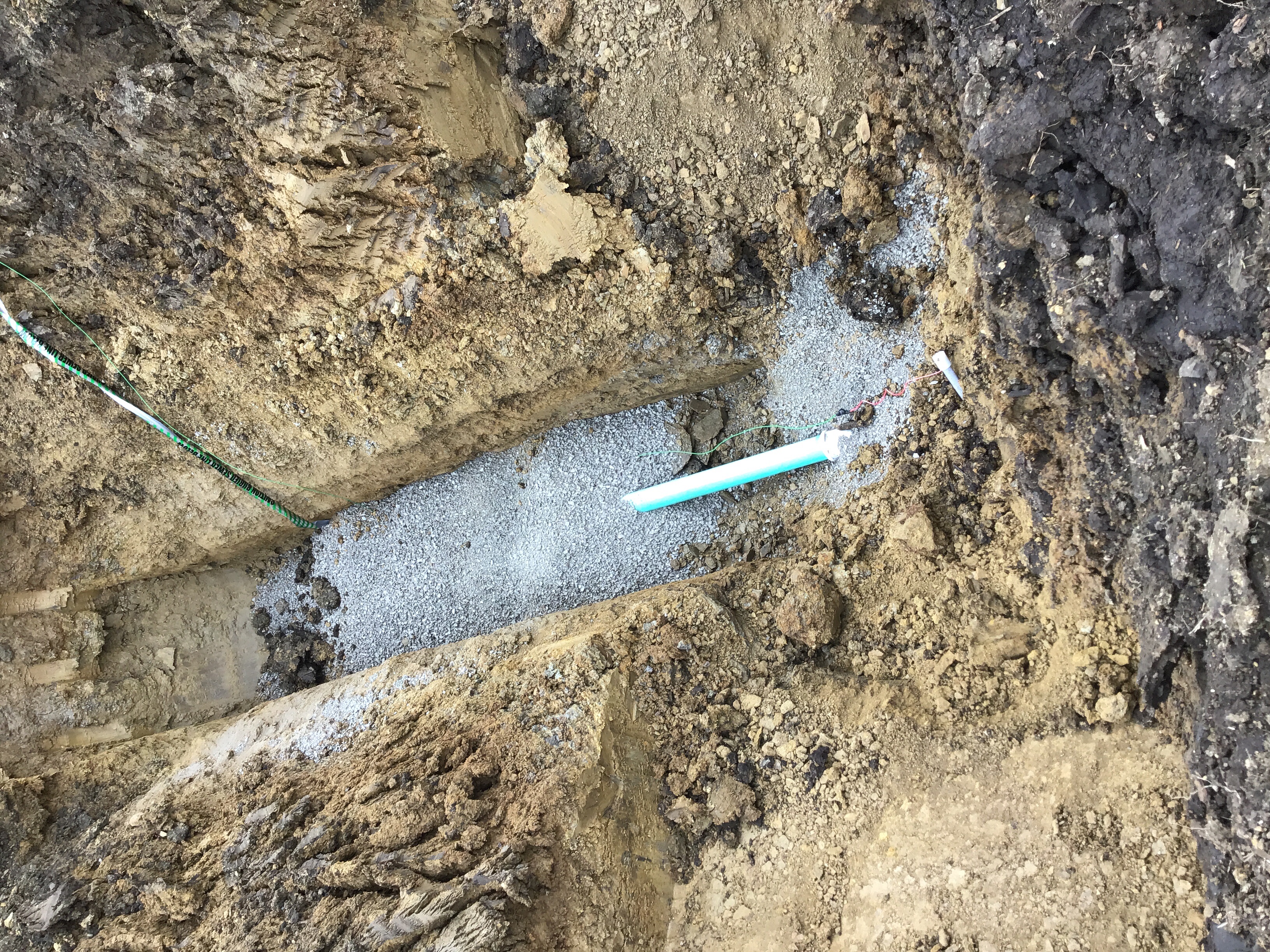

The Redford crew is continuing the install for sanitary line 3-A. The crew set MH A-1 and has the 8” sewer main installed to that point. The crew has the 4” service laterals installed for lots 52 & 53. They are currently installing the lateral for lot 51. They have flowable fill scheduled for 2pm to install the trench checks. Photos of the current progress are attached. I will return this afternoon for further inspection.
Sanitary Sewer Construction Inspection Partial 3/19/2019 03/19/2019
Misc
Informational
03/19/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Sanitary Sewer Construction Inspection Partial 03/20/2019
Misc
Informational
03/19/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
03/20/2019

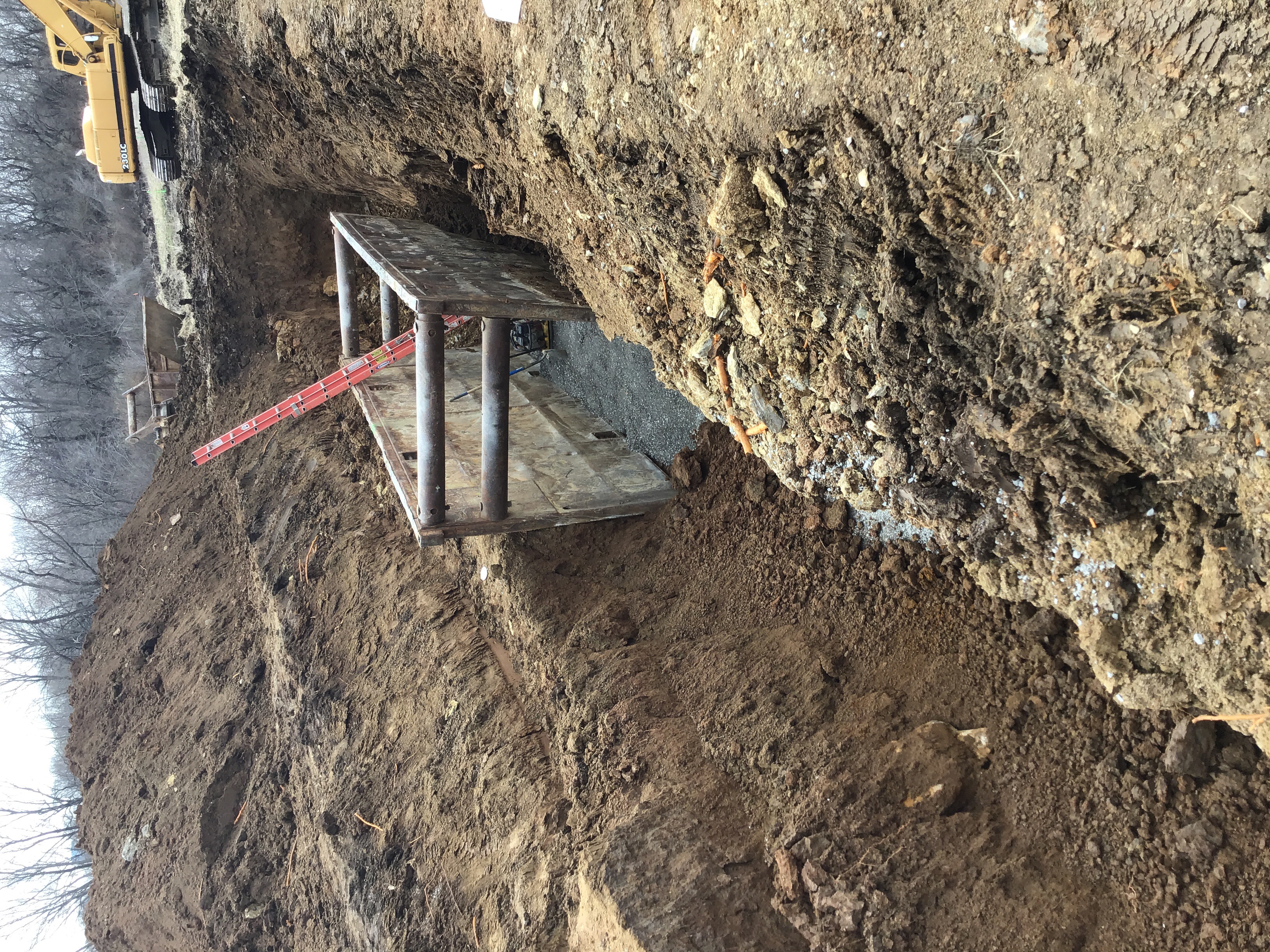

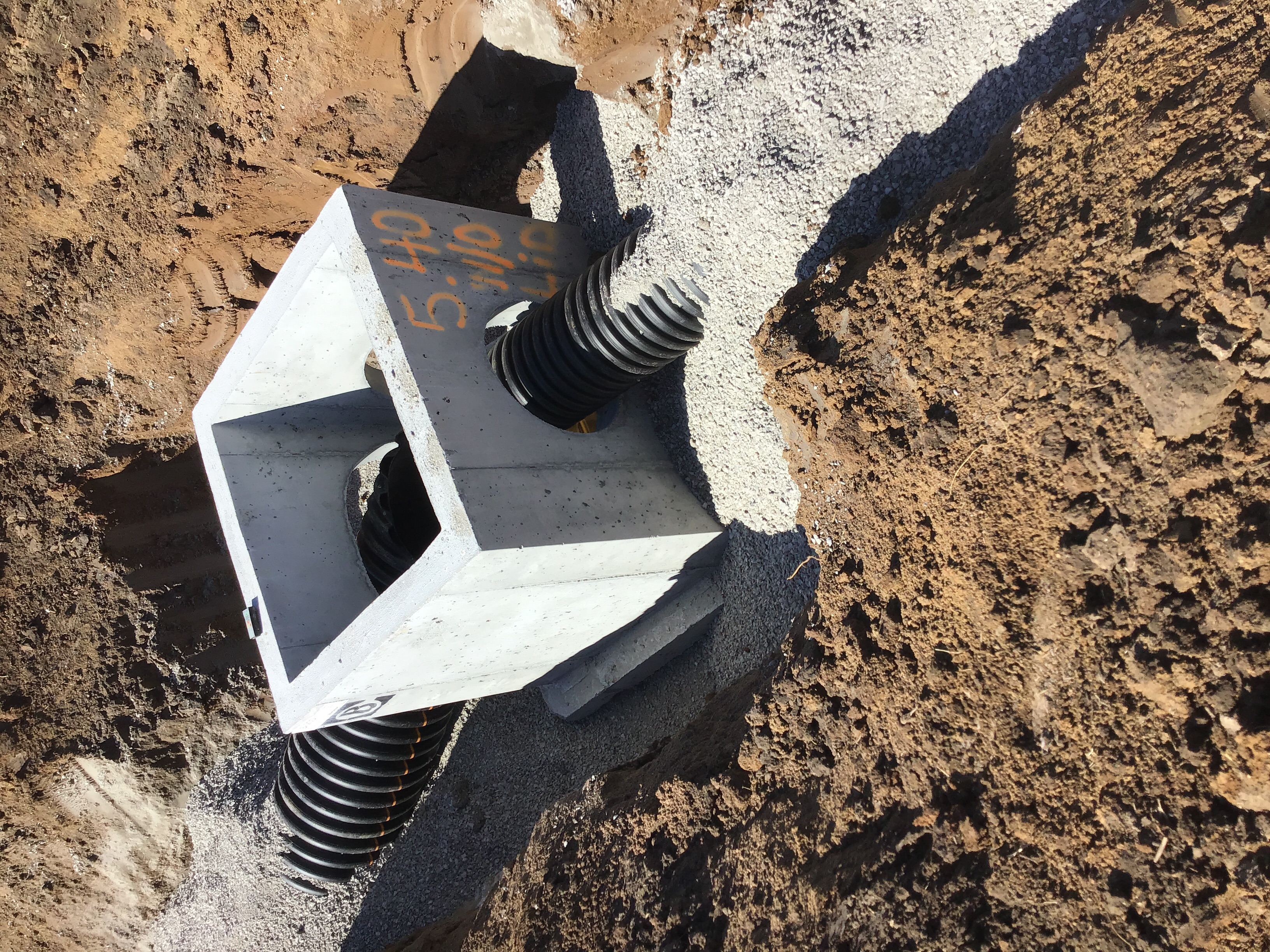

The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Sanitary Sewer Construction Inspection Partial 3/20/2019 03/21/2019
Misc
Informational
03/20/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
03/20/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
03/21/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Sanitary Sewer Construction Inspection Partial 3/21/2019 03/26/2019
Misc
Informational
03/21/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
03/21/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
03/21/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
03/26/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Sanitary Sewer Construction Inspection Partial 3/27/2019 04/01/2019
Misc
Informational
03/26/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
03/26/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
03/26/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
03/26/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
03/27/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/01/2019
The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Sanitary Sewer Construction Inspection Partial 04/01/2019
Misc
Informational
04/01/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
04/01/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
04/01/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
04/01/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
04/01/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/01/2019
The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Misc
Informational
04/01/2019

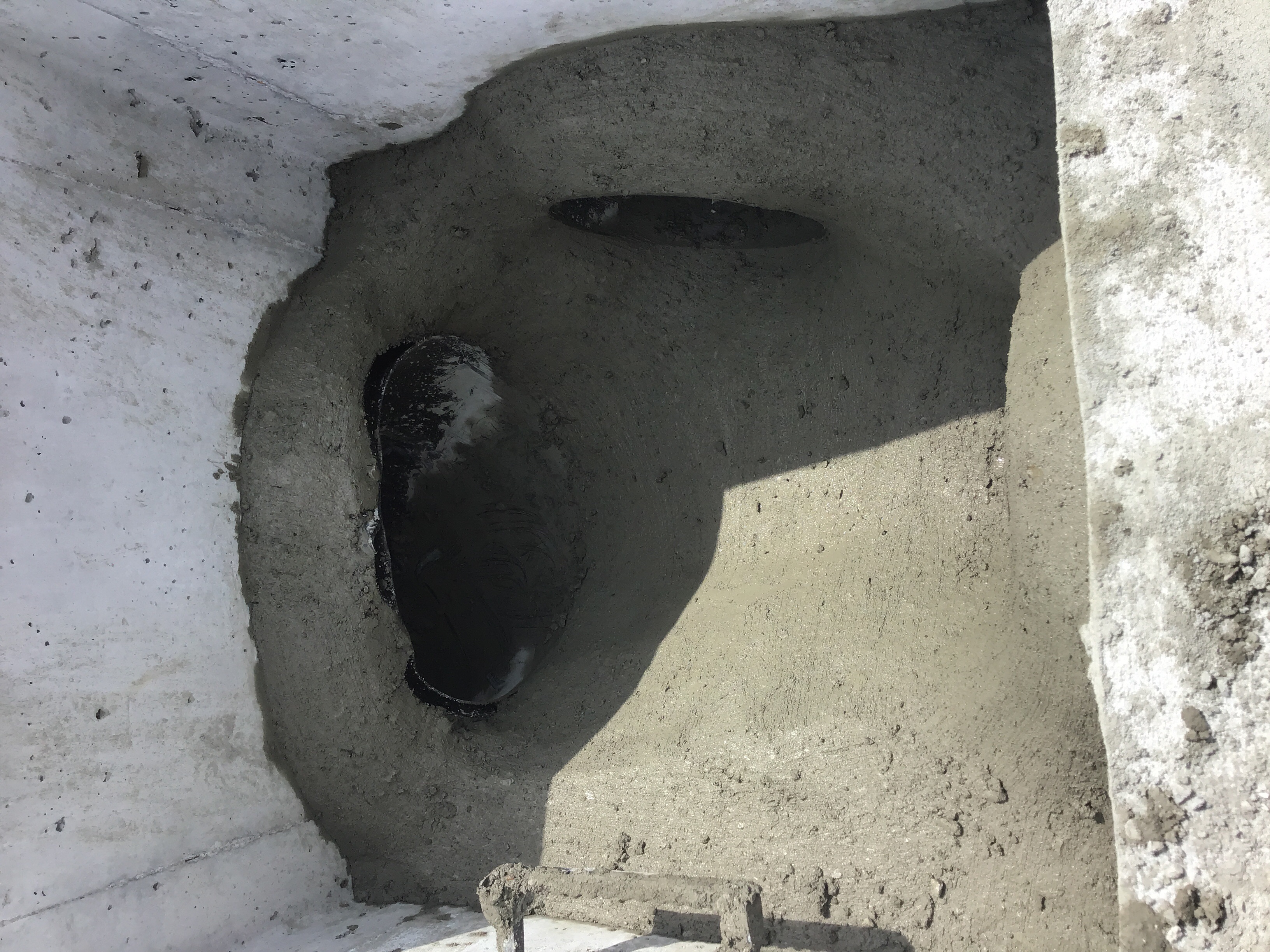

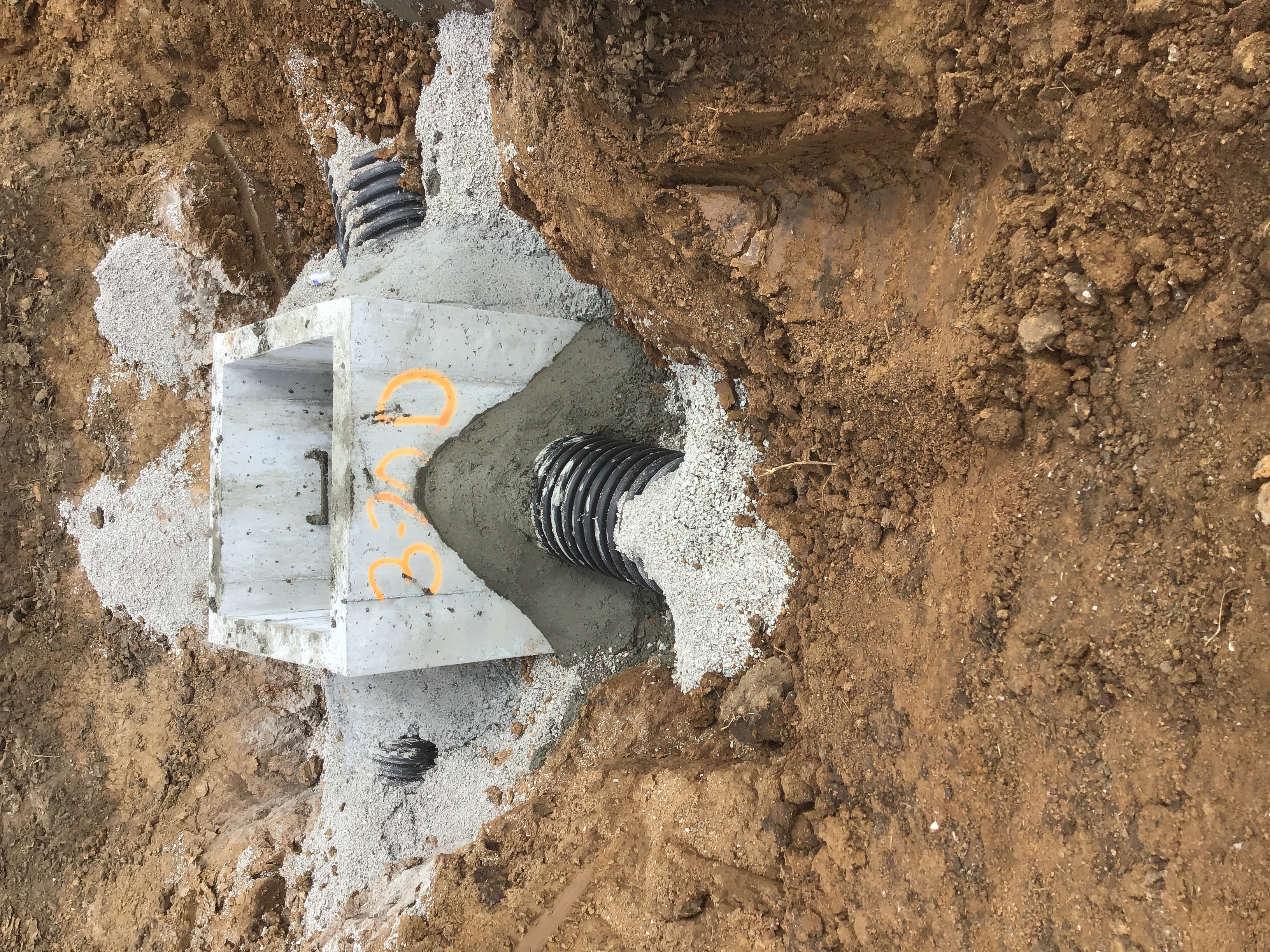

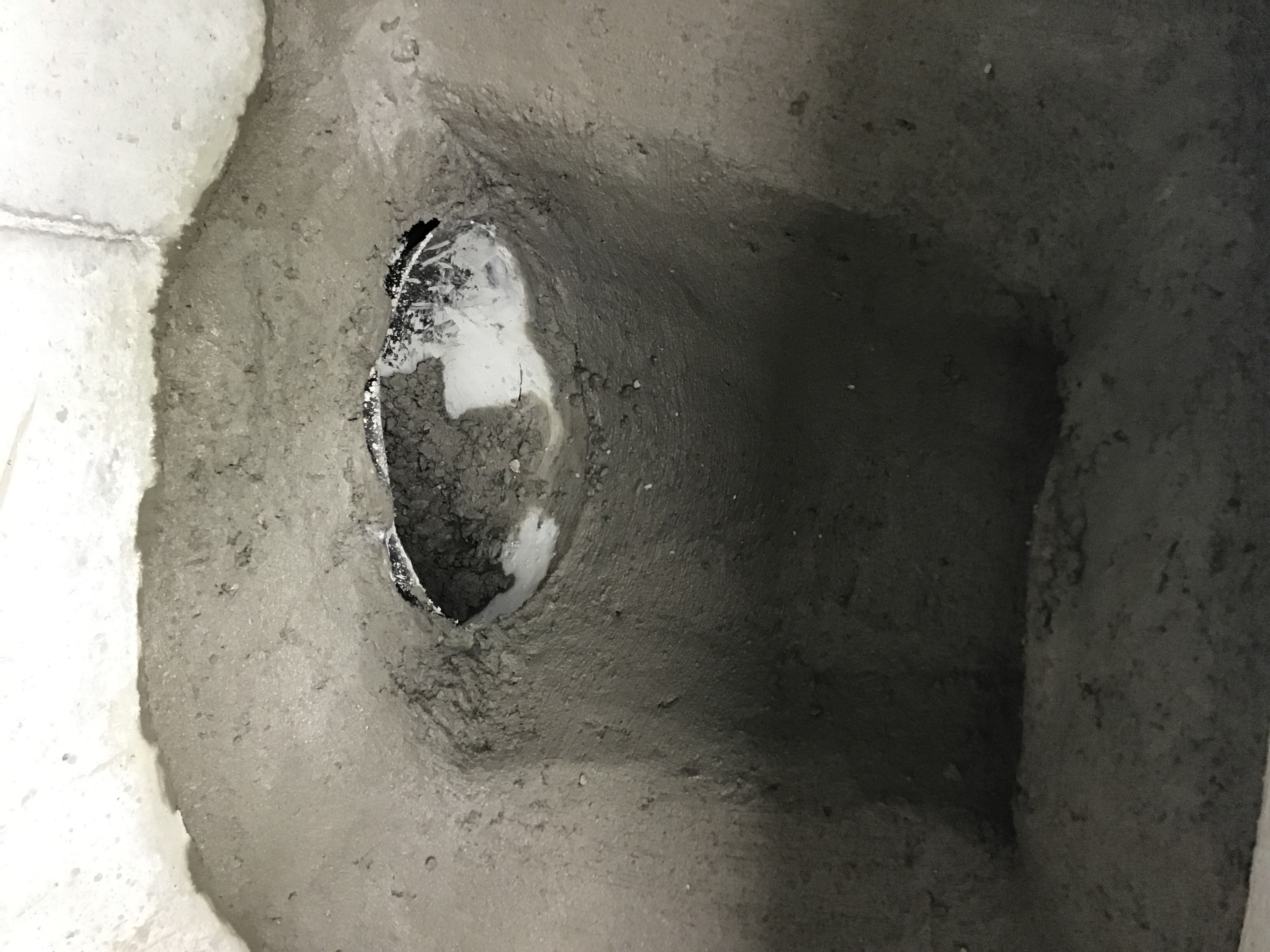

The Redford crew cored into the existing MH 55-59 at station 2+75.64 They have MH B-1 set and the pipe run between the two manholes.
Sanitary Sewer Construction Inspection Partial 4/2/2019 04/02/2019
Misc
Informational
04/01/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
04/01/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
04/01/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
04/01/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
04/01/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/01/2019
The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Misc
Informational
04/01/2019
The Redford crew cored into the existing MH 55-59 at station 2+75.64 They have MH B-1 set and the pipe run between the two manholes.
Misc
Informational
04/02/2019
Redford is continuing the sanitary install for line B. The crew is breaking rock just south of MH B-1 for their trench. I will return today for further inspection.
Sanitary Sewer Construction Inspection Partial 4/2/2019 04/03/2019
Misc
Informational
04/02/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
04/02/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
04/02/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
04/02/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
04/02/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/02/2019
The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Misc
Informational
04/02/2019
The Redford crew cored into the existing MH 55-59 at station 2+75.64 They have MH B-1 set and the pipe run between the two manholes.
Misc
Informational
04/02/2019
Redford is continuing the sanitary install for line B. The crew is breaking rock just south of MH B-1 for their trench. I will return today for further inspection.
Misc
Informational
04/03/2019

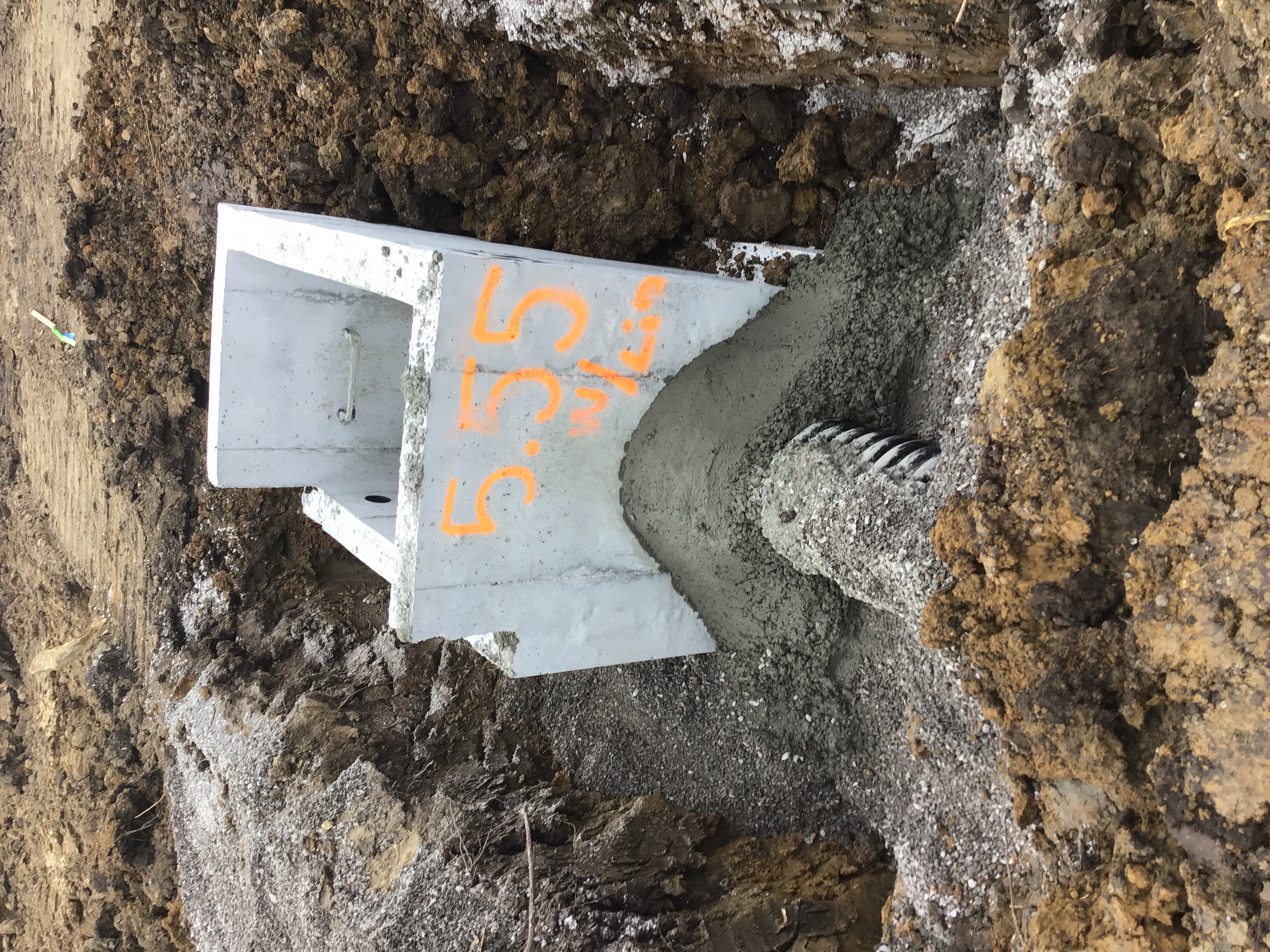

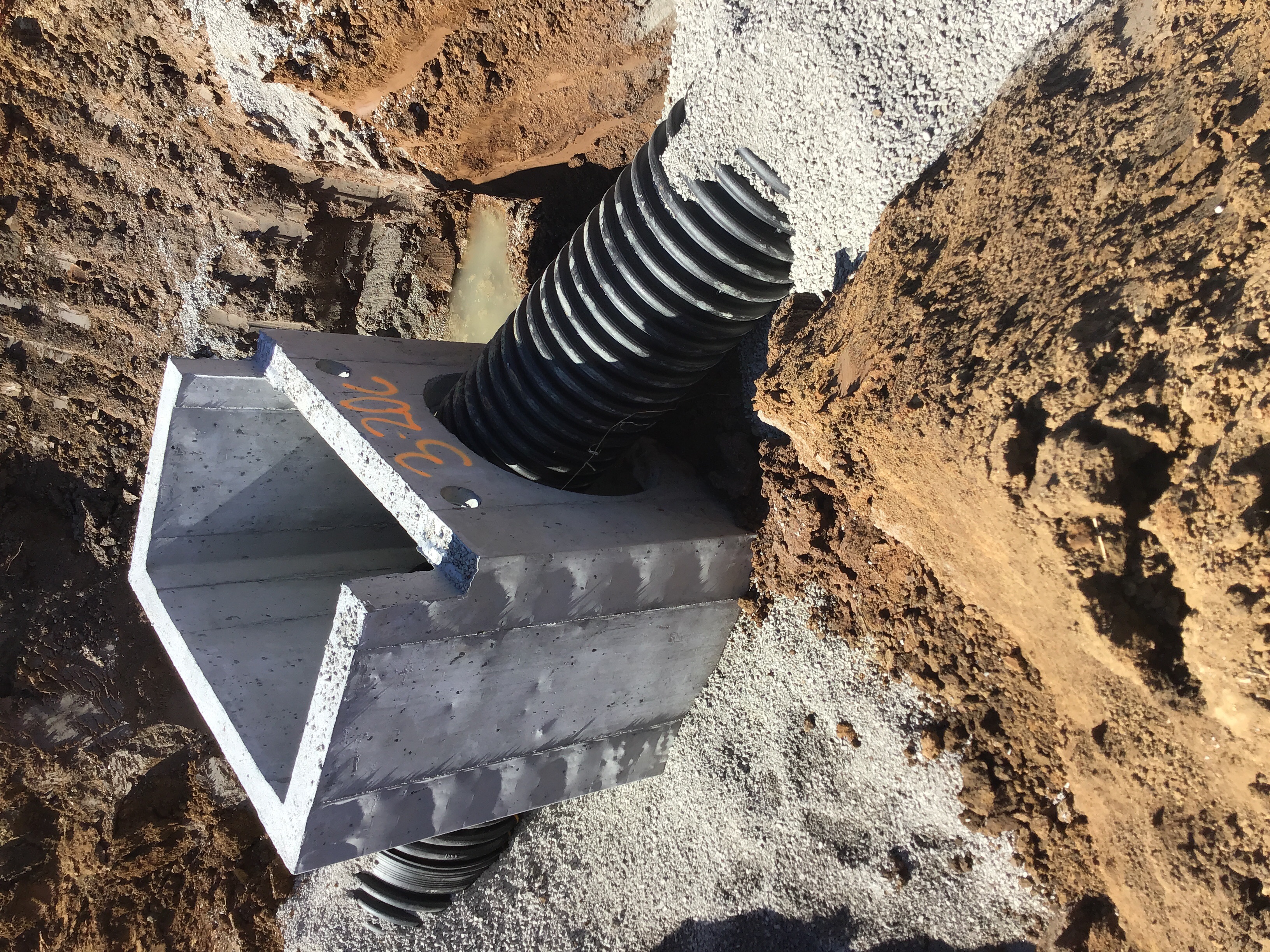

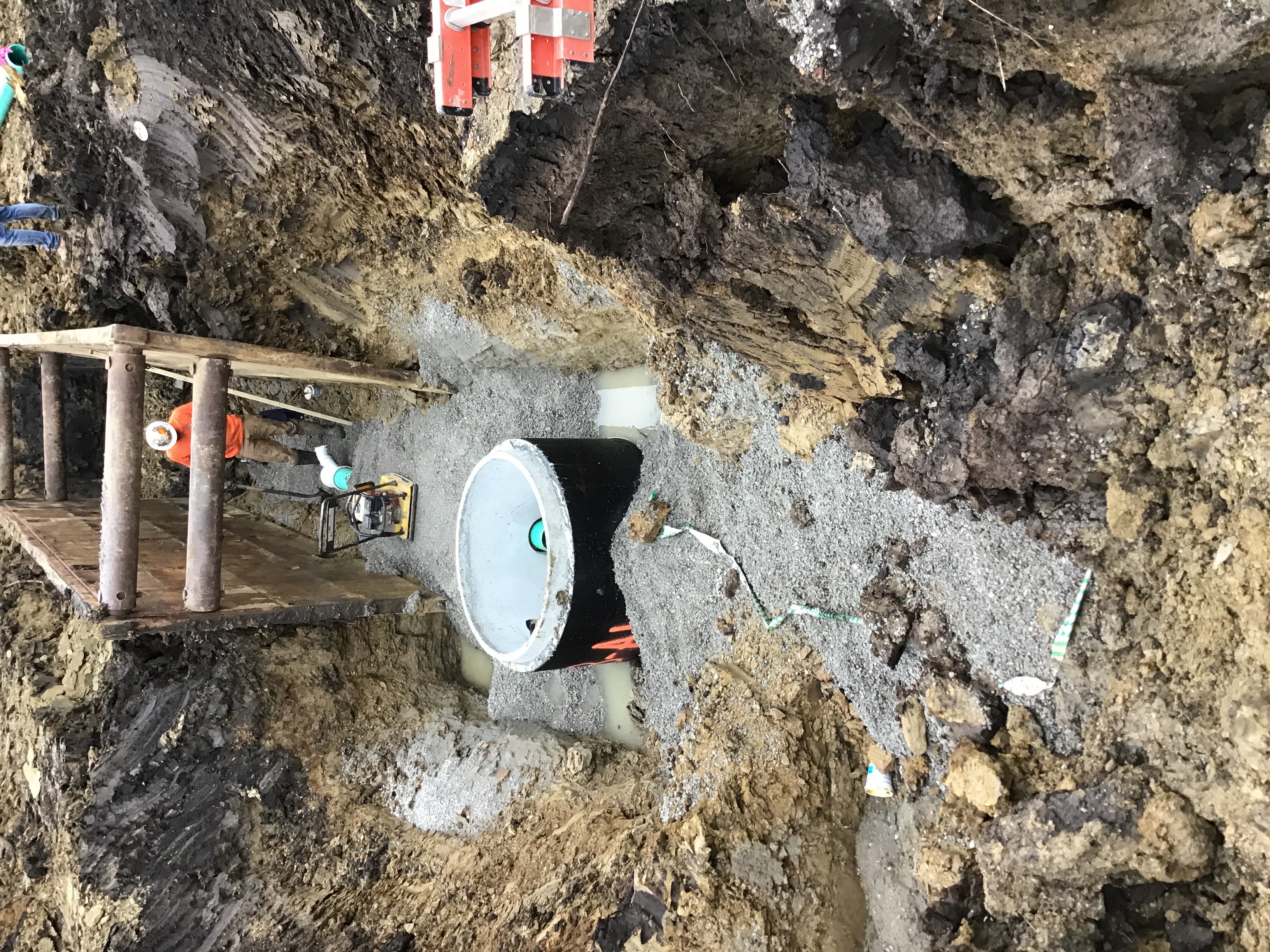

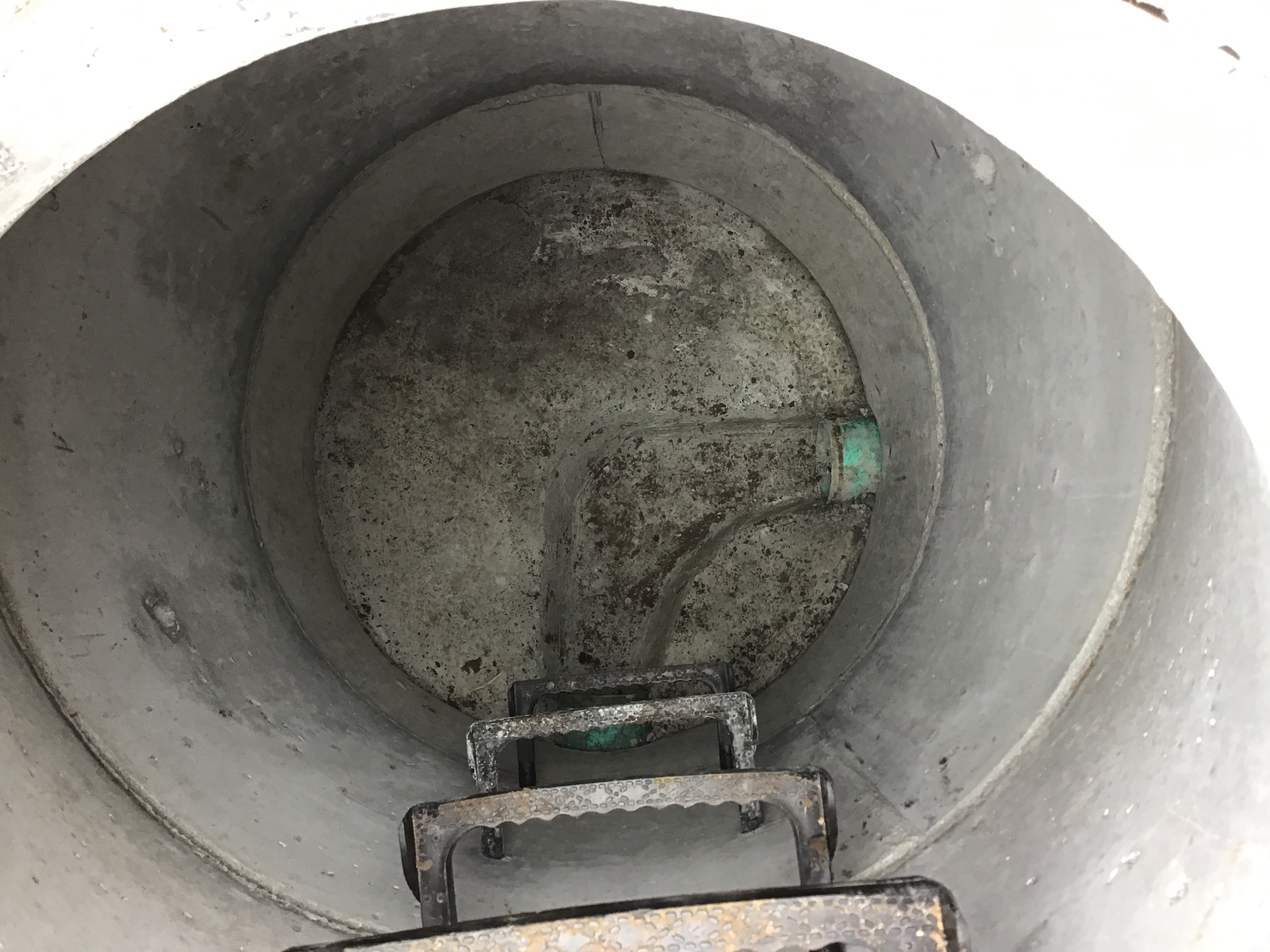

The Redford crew has set MH B-2 and poured the inverts for MH B-1 & MH B-2, photos are attached. The 8” sewer line is ran between these manholes and run to approximately station 4+00.
Sanitary Sewer Construction Inspection Partial 4/3/2019 04/09/2019
Misc
Informational
04/03/2019
The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
04/03/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
04/03/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
04/03/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
04/03/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/03/2019
The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Misc
Informational
04/03/2019

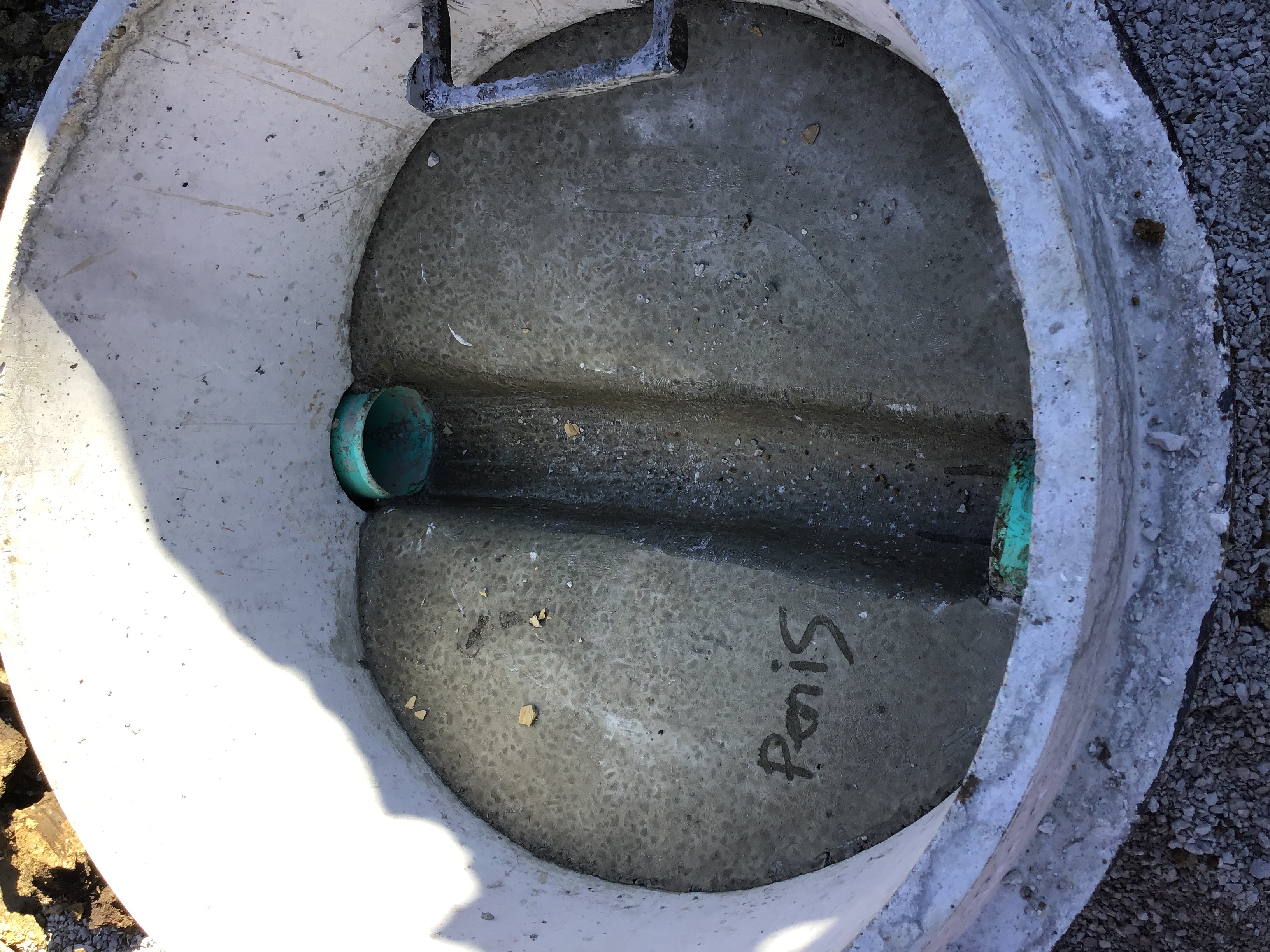

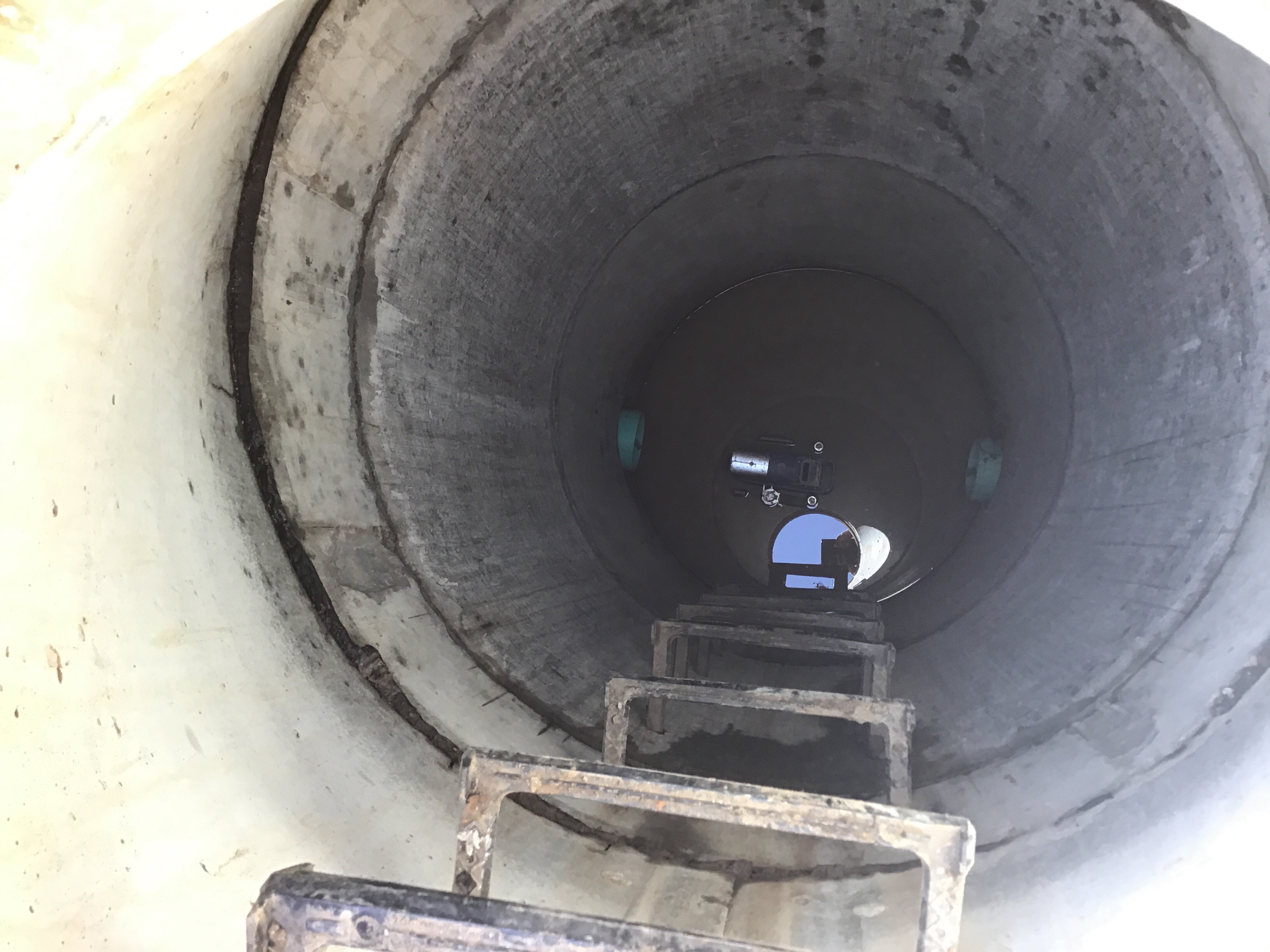

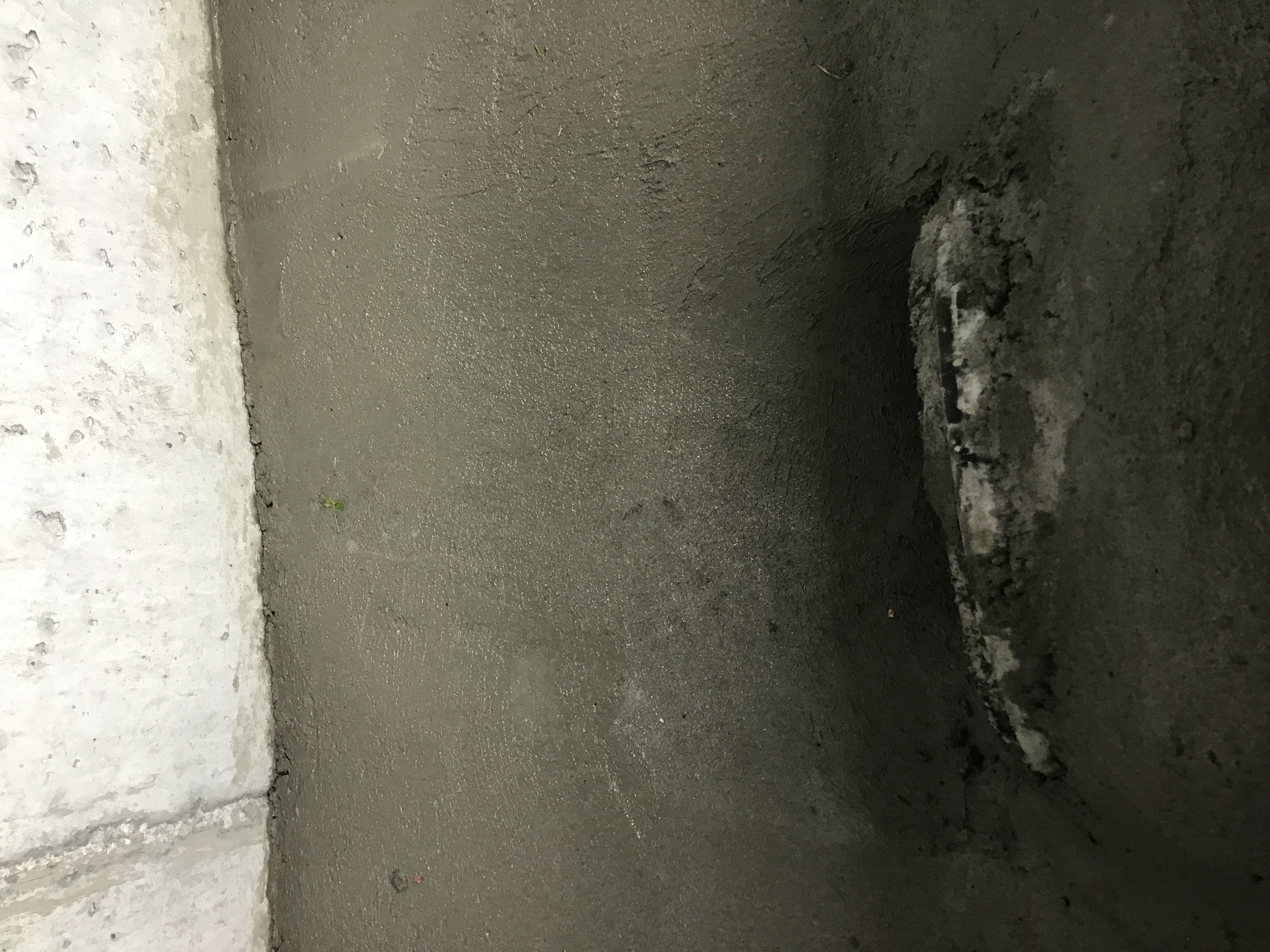

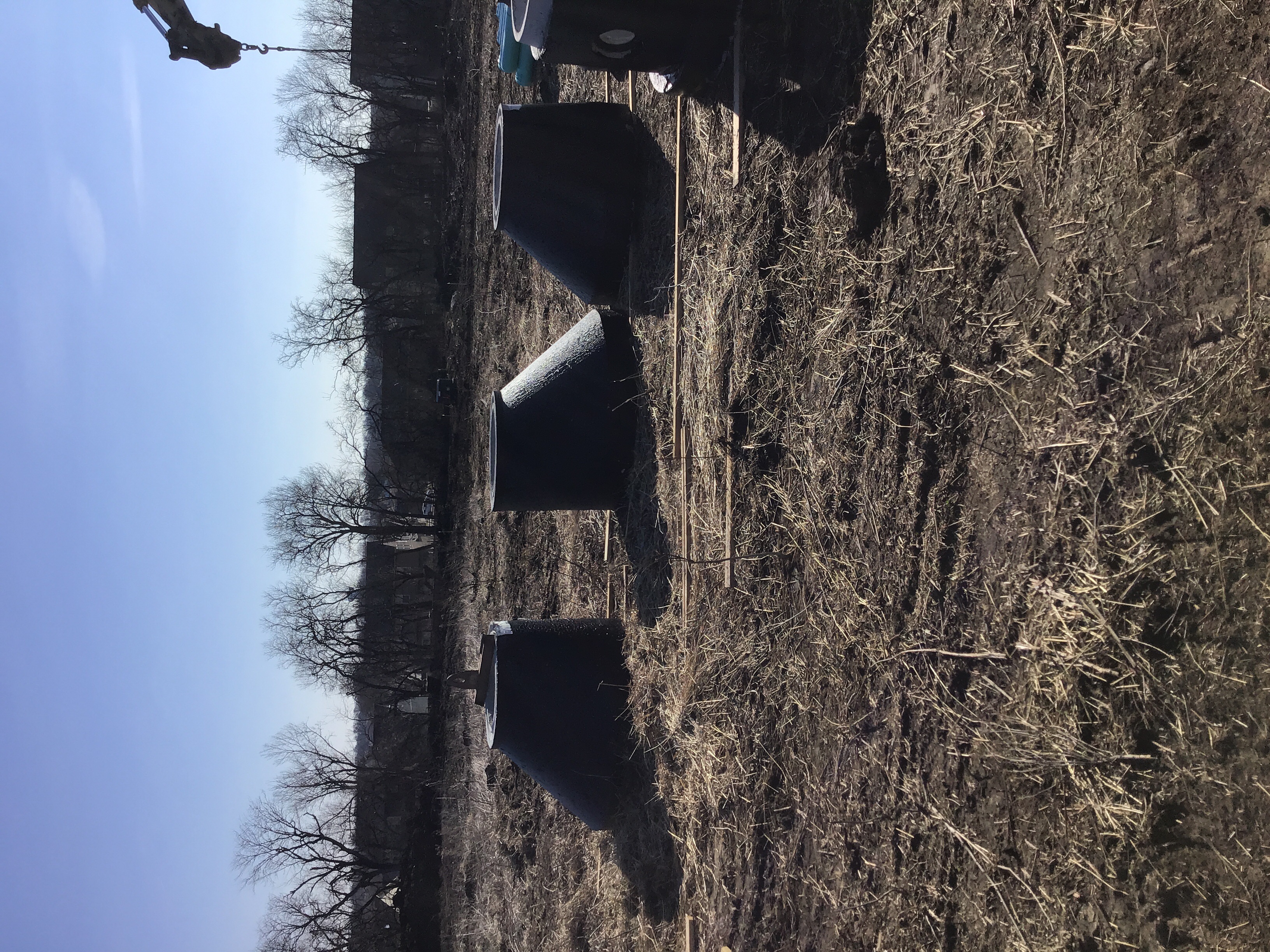

The Redford crew cored into the existing MH 55-59 at station 2+75.64 They have MH B-1 set and the pipe run between the two manholes.
Misc
Informational
04/03/2019

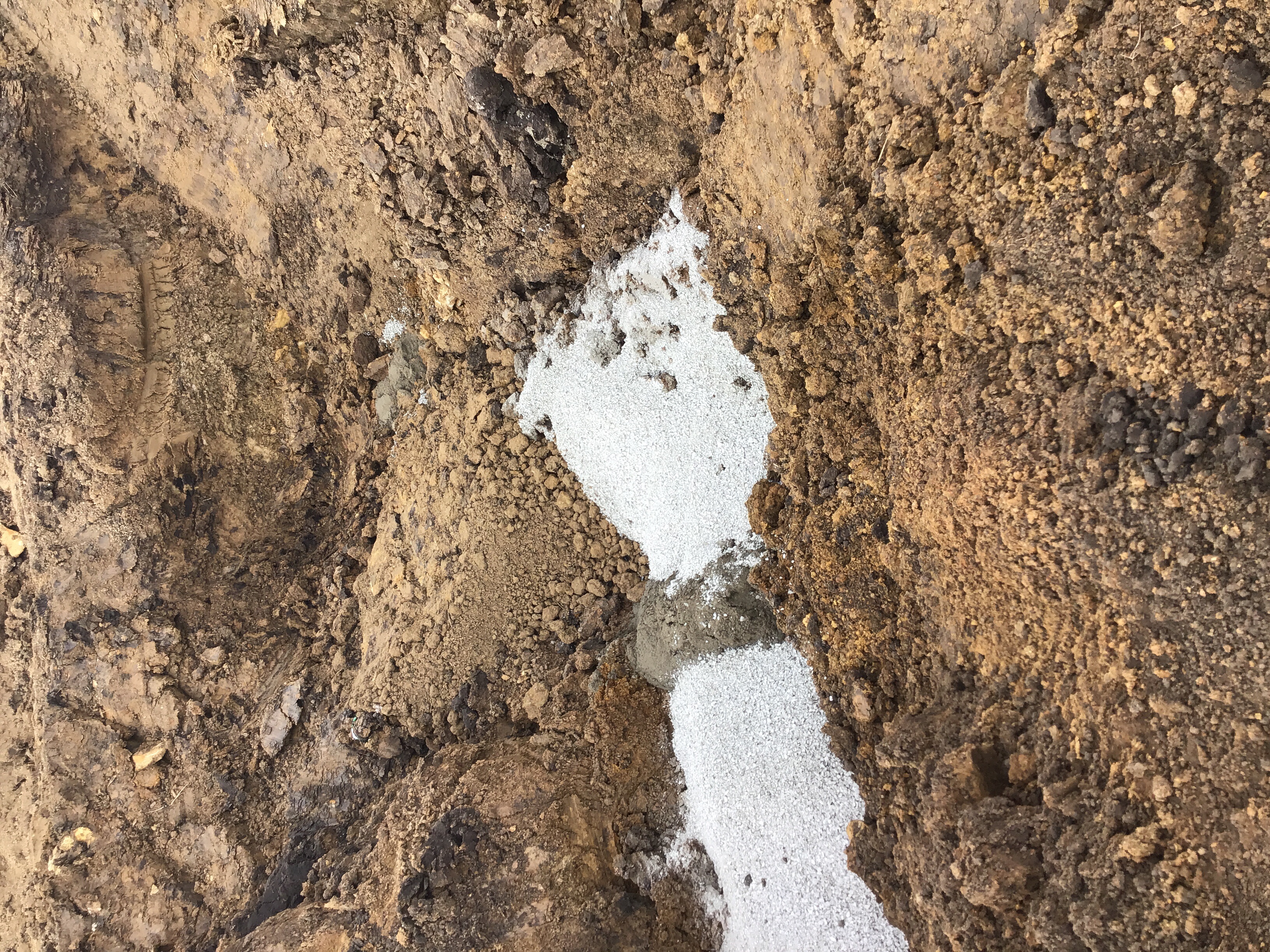

Redford is continuing the sanitary install for line B. The crew is breaking rock just south of MH B-1 for their trench. I will return today for further inspection.
Misc
Informational
04/03/2019

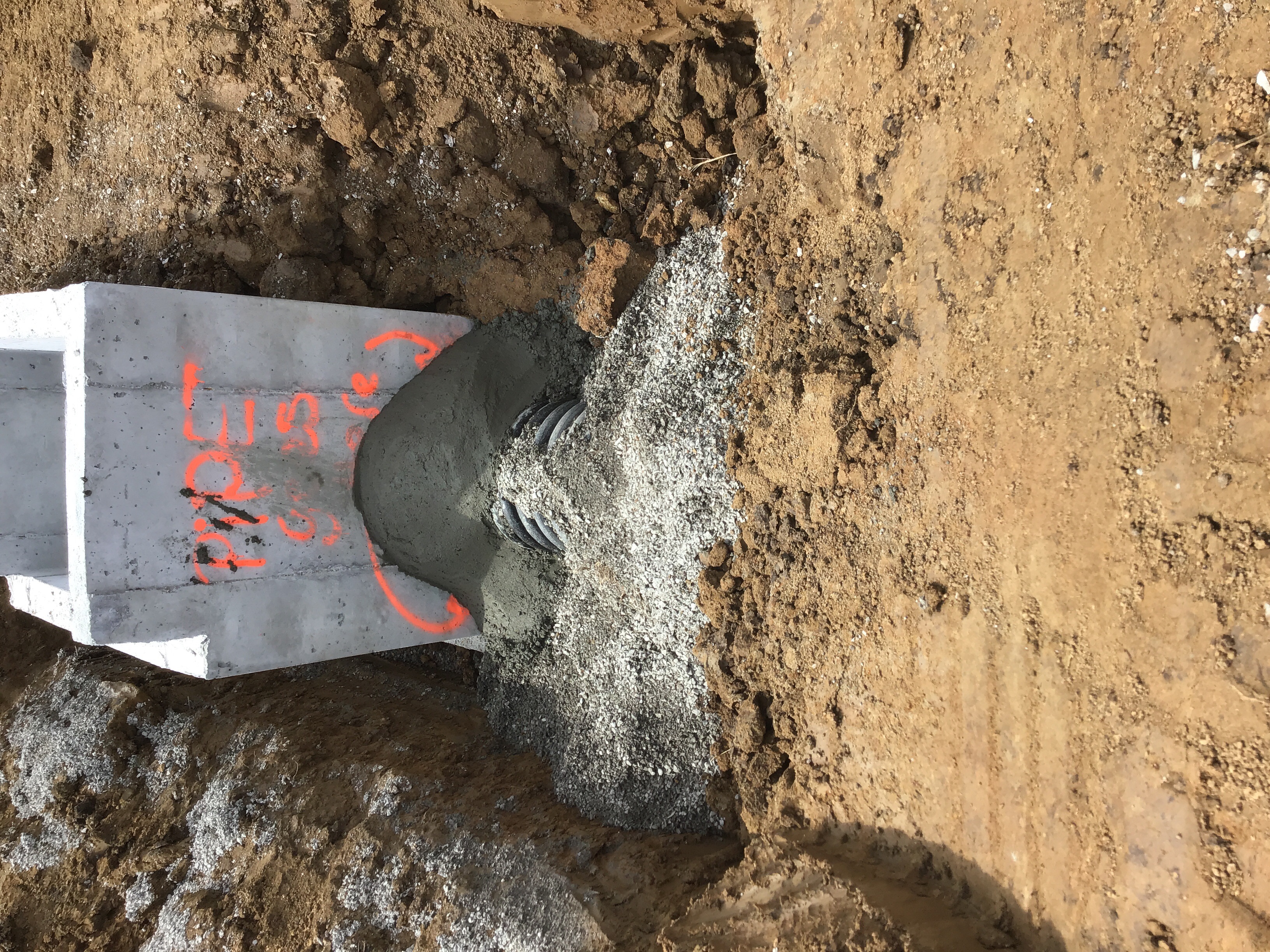

The Redford crew has set MH B-2 and poured the inverts for MH B-1 & MH B-2, photos are attached. The 8” sewer line is ran between these manholes and run to approximately station 4+00.
Misc
Informational
04/09/2019

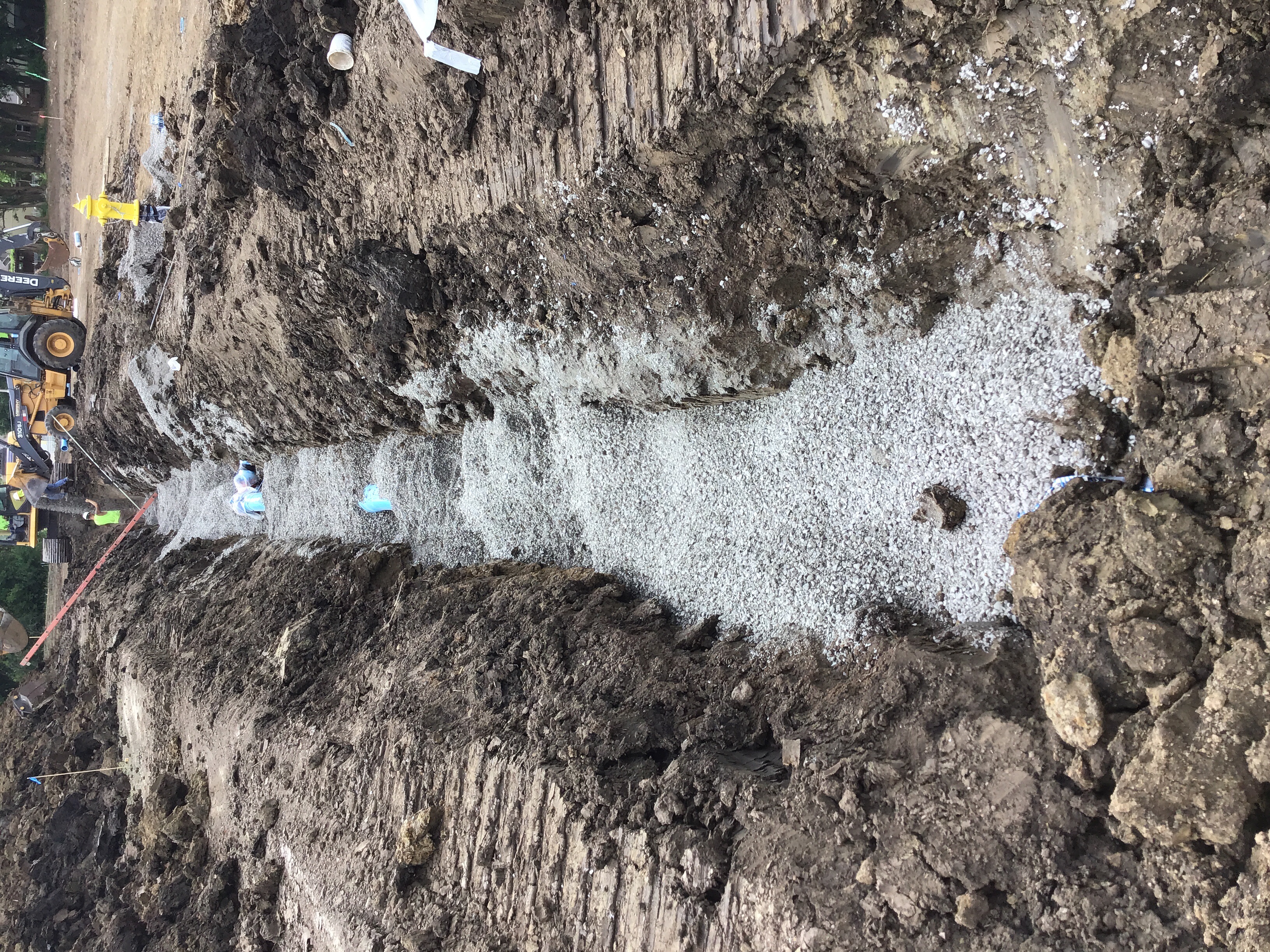

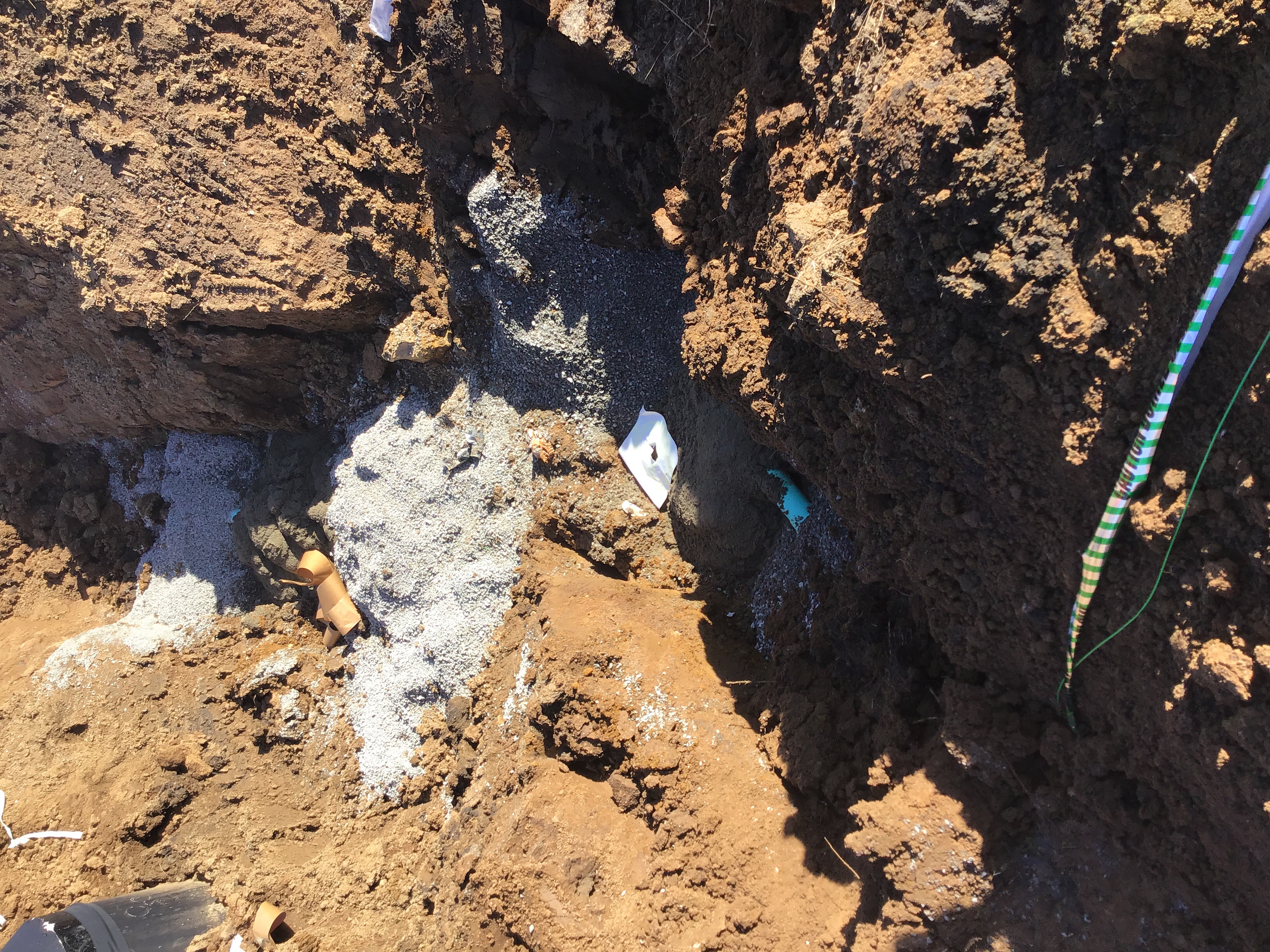

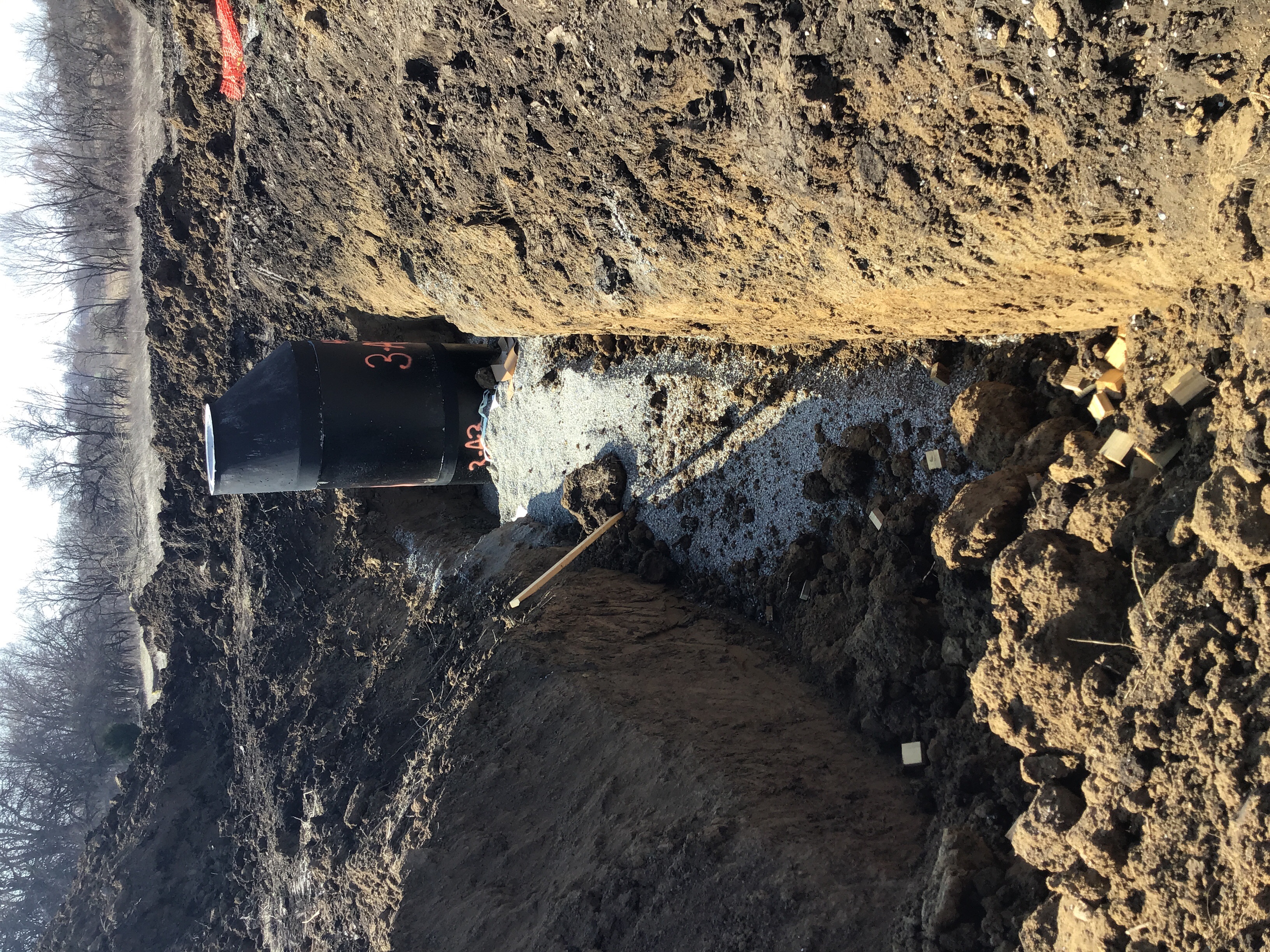

The Redford crew installed the remainder of sanitary line B. The manholes are set and the inverts are poured. Photos attached. The service laterals for the remainder of the lots are installed and the crew poured the trench checks today. The crew will let the flow fill set up before backfilling. KC Testing Lab will be onsite today to test the 11 road crossings.
Sanitary Sewer Construction Inspection Partial 4/9/2019 04/09/2019
Misc
Informational
04/09/2019

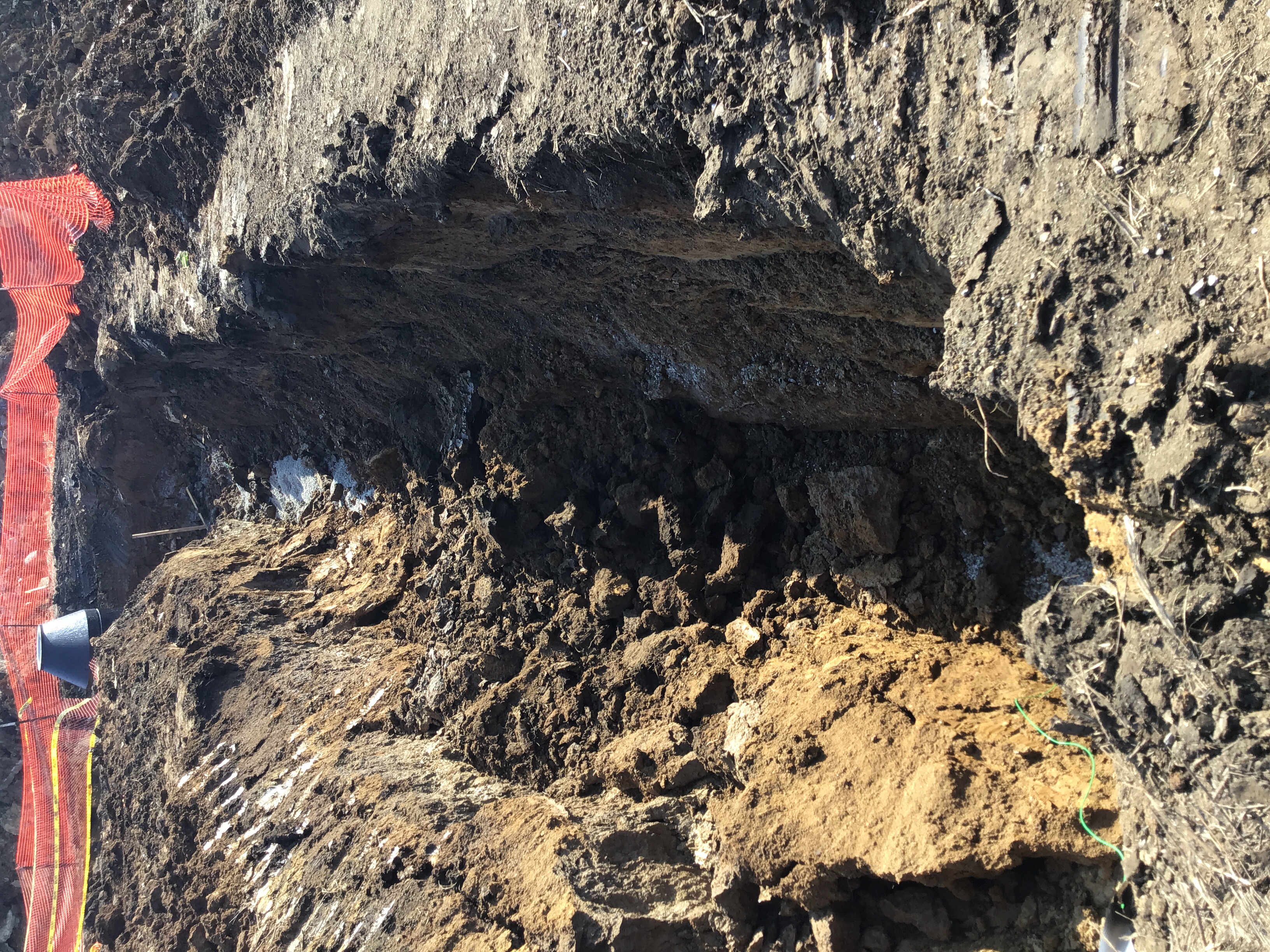

The Redford crew is continuing the sanitary install for line 3-A. The crew set MH A-2 and has the 8” line installed from MH A-1 to A-2. The crew poured the invert for MH A-1 yesterday. Photos are attached. The crew also installed the service lateral for lot 63 and plans to pour the trench check this afternoon. I will return for further inspection this afternoon.
Misc
Informational
04/09/2019
The Redford crew installed the trench checks for lots 51, 52, 53, 54, 64 & 65. The checks appeared to be installed according to the city standards. The crew is continuing the install to the south from MH A-1.
Misc
Informational
04/09/2019
The Redford crew is continuing the install of sanitary line 3-A. They installed the service laterals for lots 64 & 65. The crew plans to pour the trench checks later this afternoon when the fill arrives. The crew is going to leave the trench checks exposed for me to insect first thing in the morning.
Misc
Informational
04/09/2019
The Redford crew is continuing the install for sanitary sewer line 3-A. The crew has MH A-3 set and the 8” main line run between A-2 & A-3. The crew has the service laterials set for lots 62 & 61 and plans to pour the trench checks this afternoon. The install appears to match the approved plans and meets the City of LS specifications. Photos are attached.
Misc
Informational
04/09/2019
The Redford crew installed the sanitary service laterals and trench checks for lots 55, 56, 57, 59, 60, & 61. Photos are attached.
Misc
Informational
04/09/2019

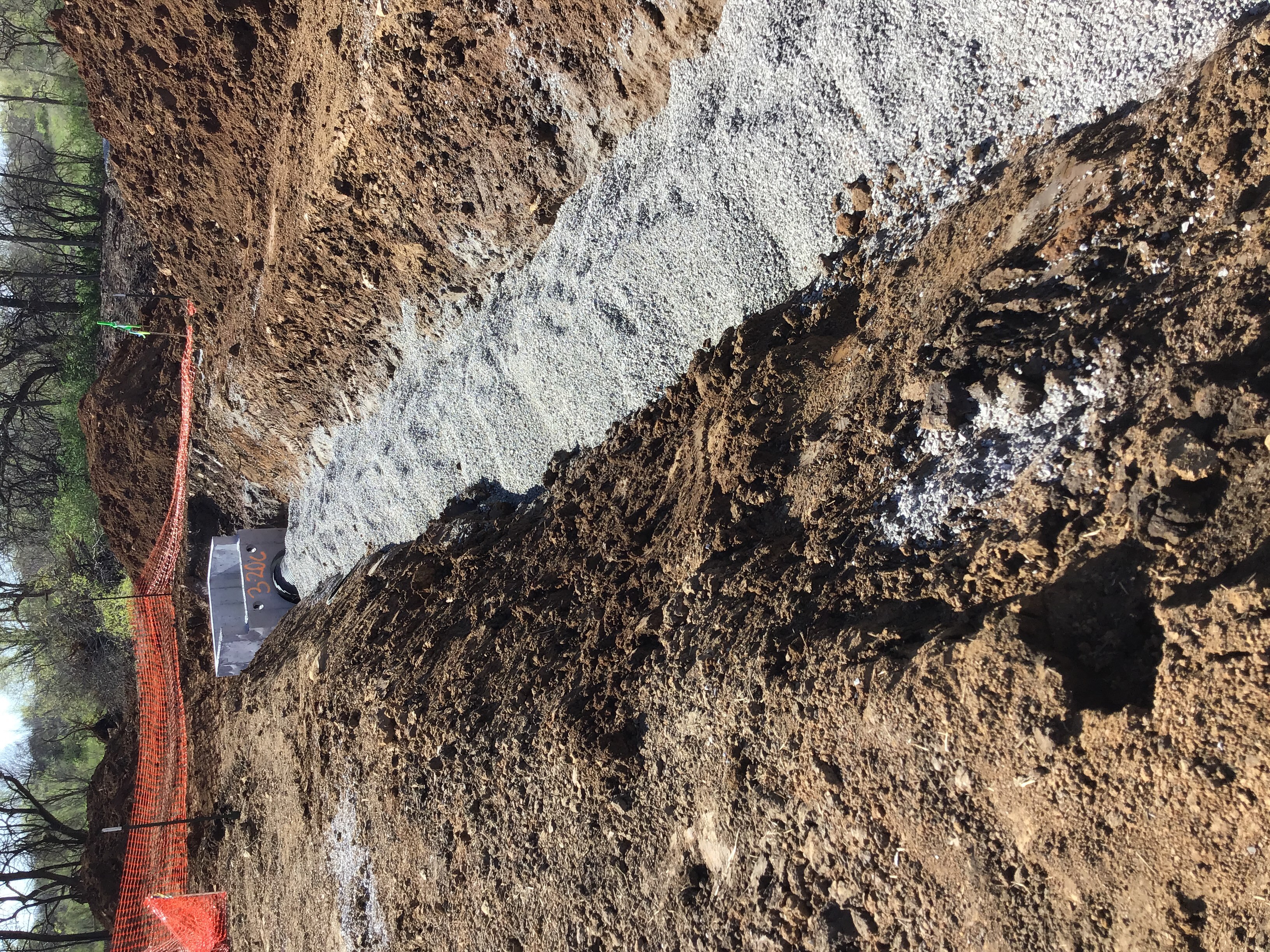

The Redford crew is preparing to core into the existing MH 55-59 at station 2+75.64 I will return for further inspection later this morning and afternoon.
Misc
Informational
04/09/2019

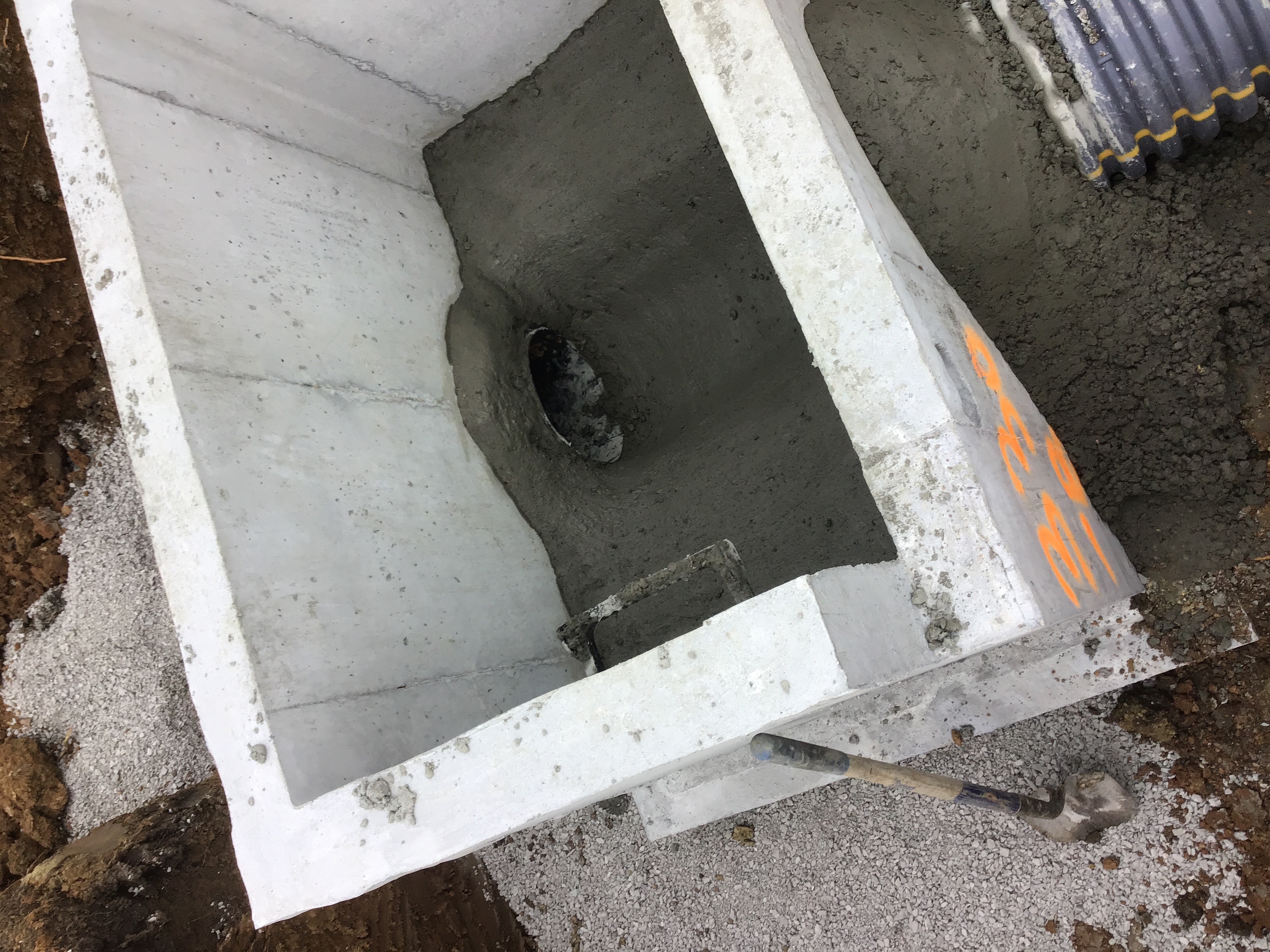

The Redford crew cored into the existing MH 55-59 at station 2+75.64 They have MH B-1 set and the pipe run between the two manholes.
Misc
Informational
04/09/2019
Redford is continuing the sanitary install for line B. The crew is breaking rock just south of MH B-1 for their trench. I will return today for further inspection.
Misc
Informational
04/09/2019
The Redford crew has set MH B-2 and poured the inverts for MH B-1 & MH B-2, photos are attached. The 8” sewer line is ran between these manholes and run to approximately station 4+00.
Misc
Informational
04/09/2019
The Redford crew installed the remainder of sanitary line B. The manholes are set and the inverts are poured. Photos attached. The service laterals for the remainder of the lots are installed and the crew poured the trench checks today. The crew will let the flow fill set up before backfilling. KC Testing Lab will be onsite today to test the 11 road crossings.
Misc
Informational

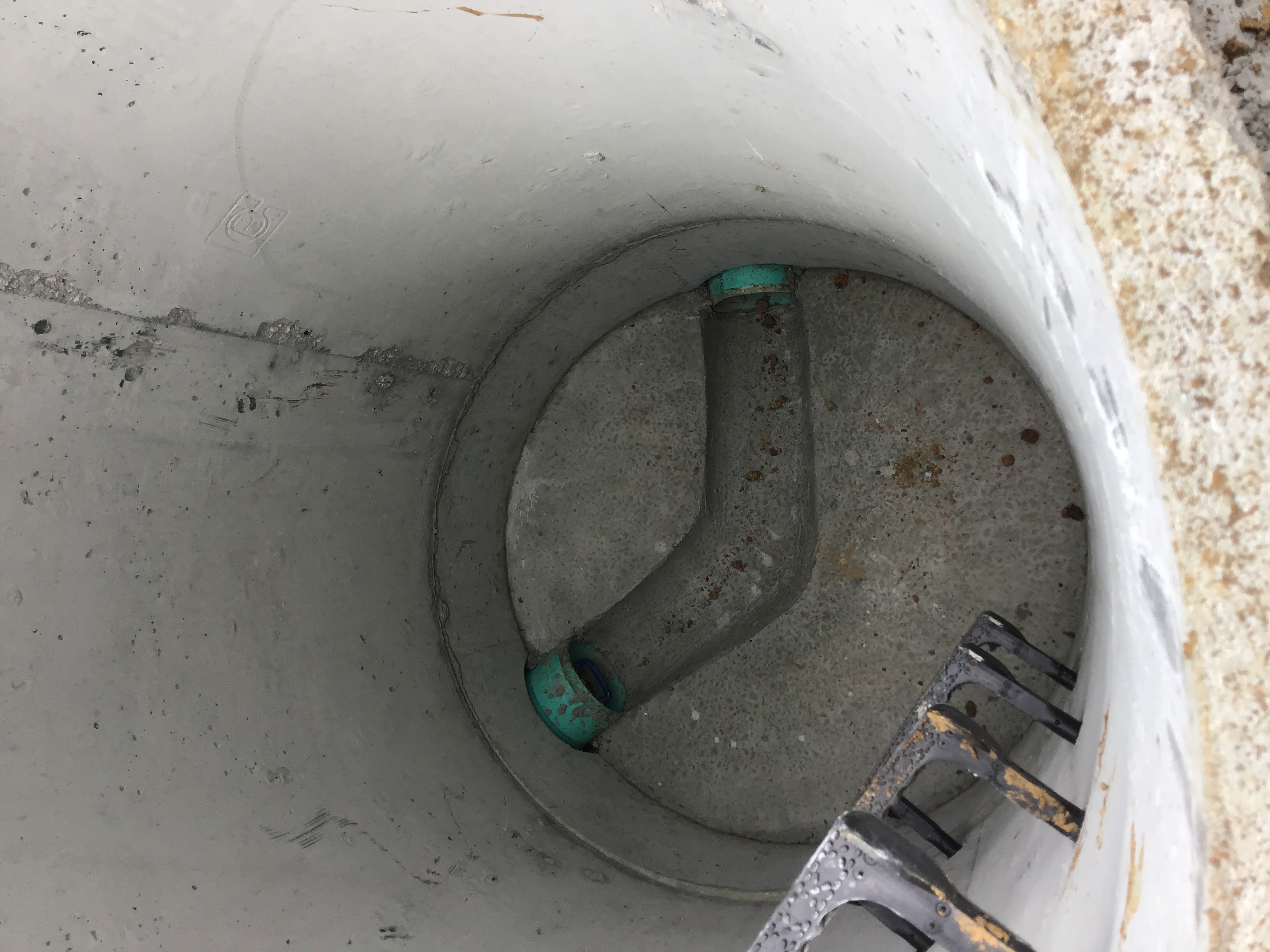

04/09/2019
KC Testing was on site to run compaction testing on the sanitary service laterals at the road crossings. The moisture content was high and their proctors were in question. The KC Testing crew took new proctors of the representing crossings to test. They will return next week for more testing.
Storm Sewer Construction Inspection Partial 4/11/2019 04/11/2019
Misc
Informational

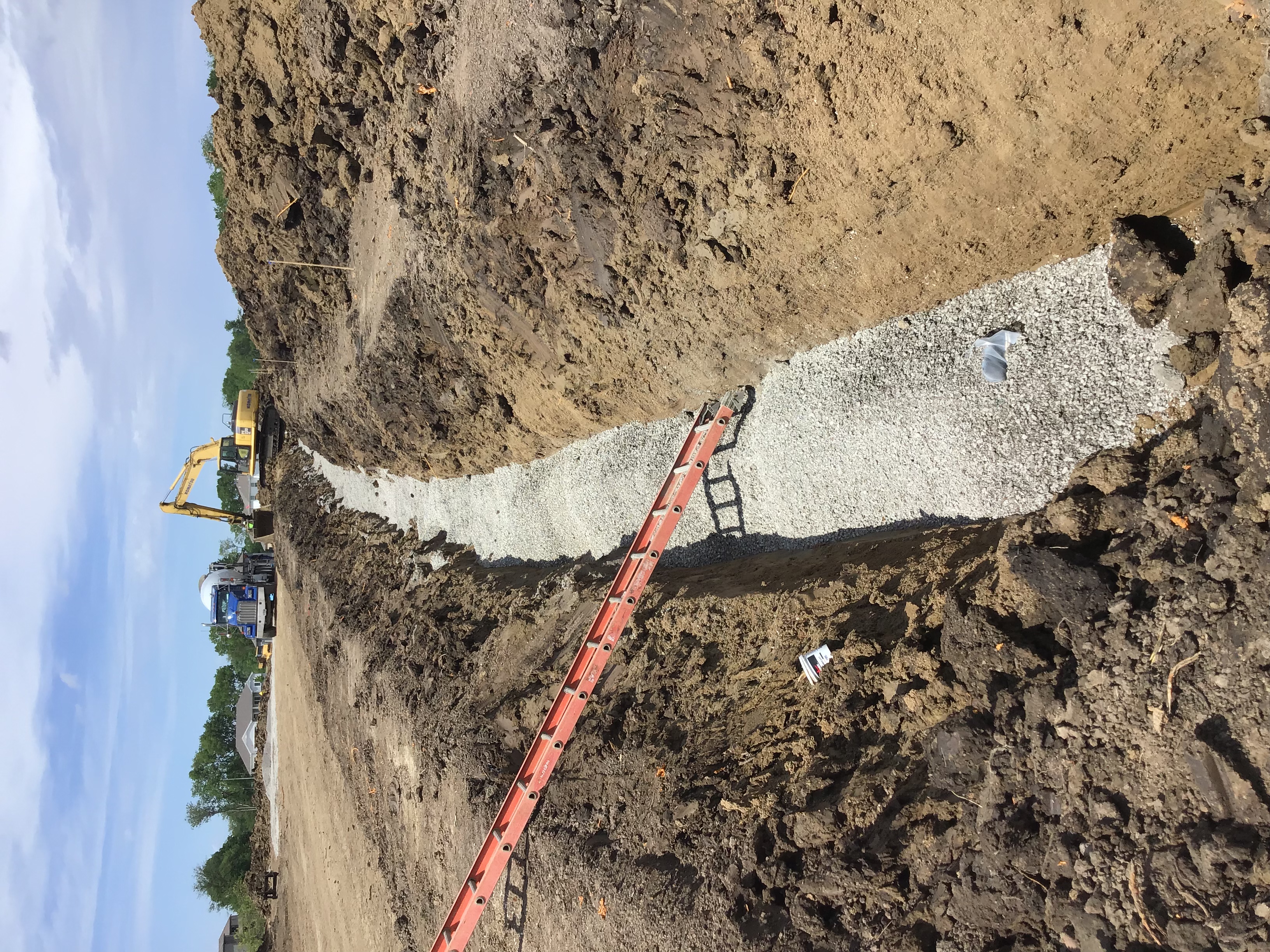

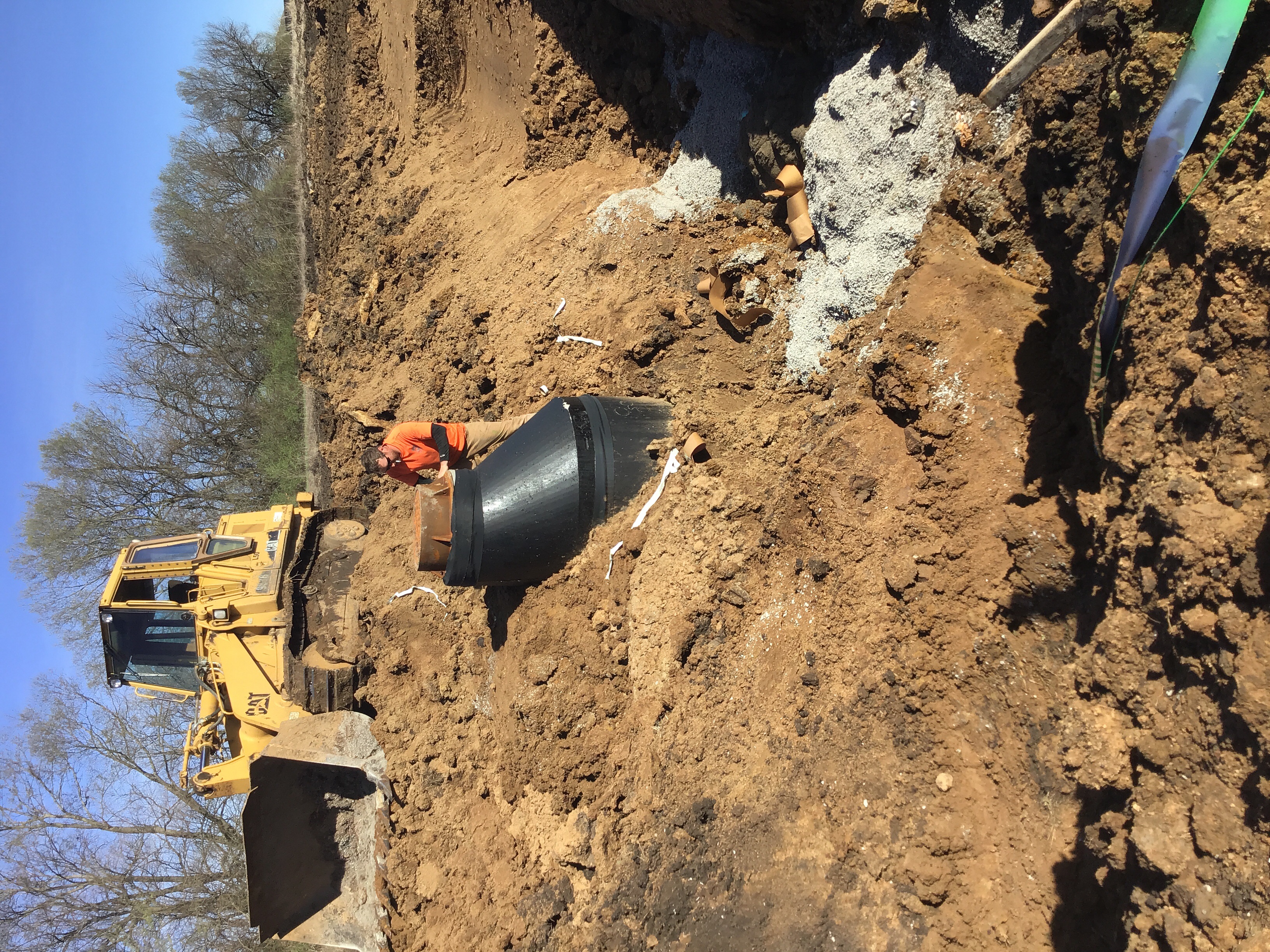

04/11/2019

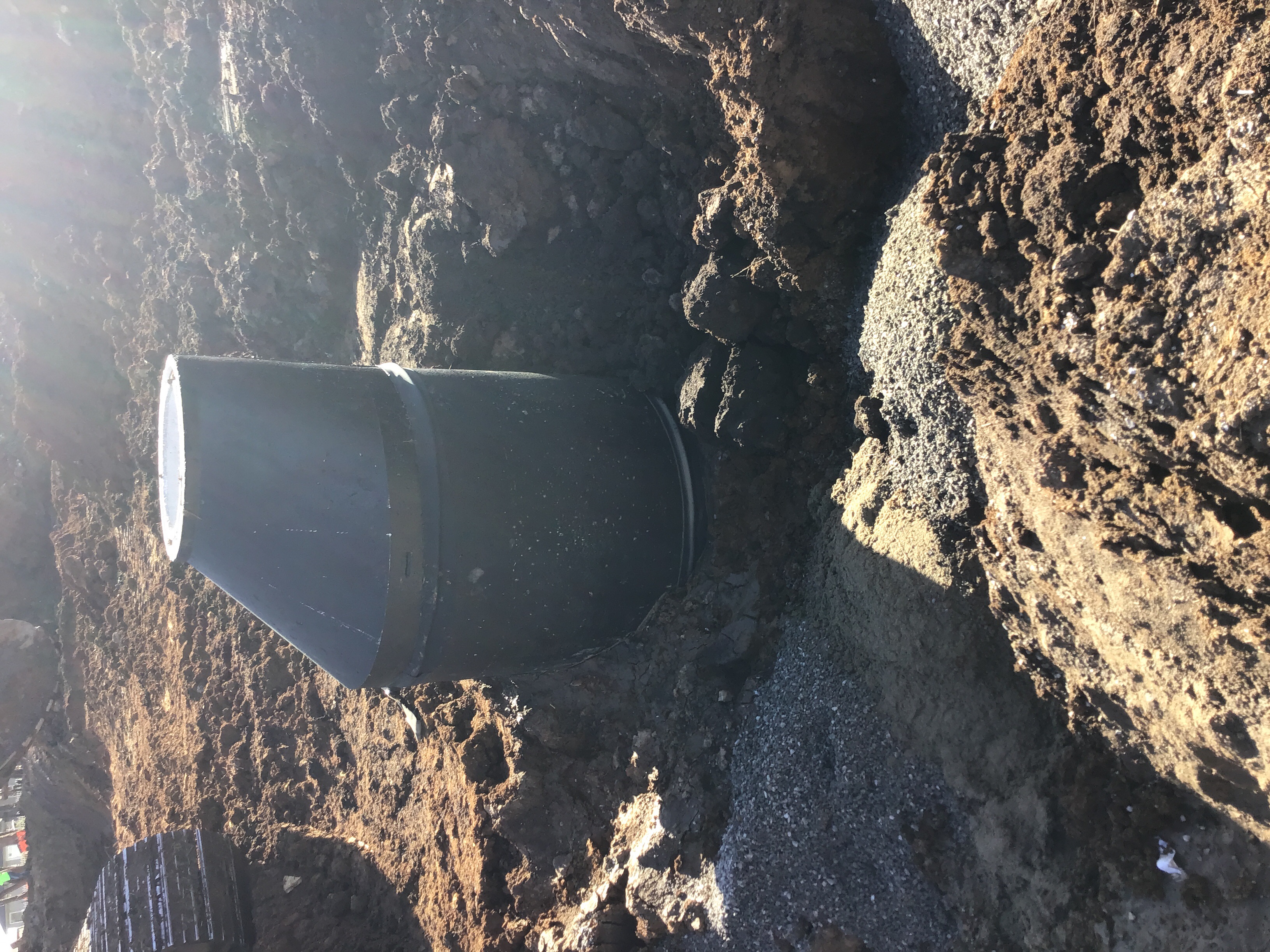

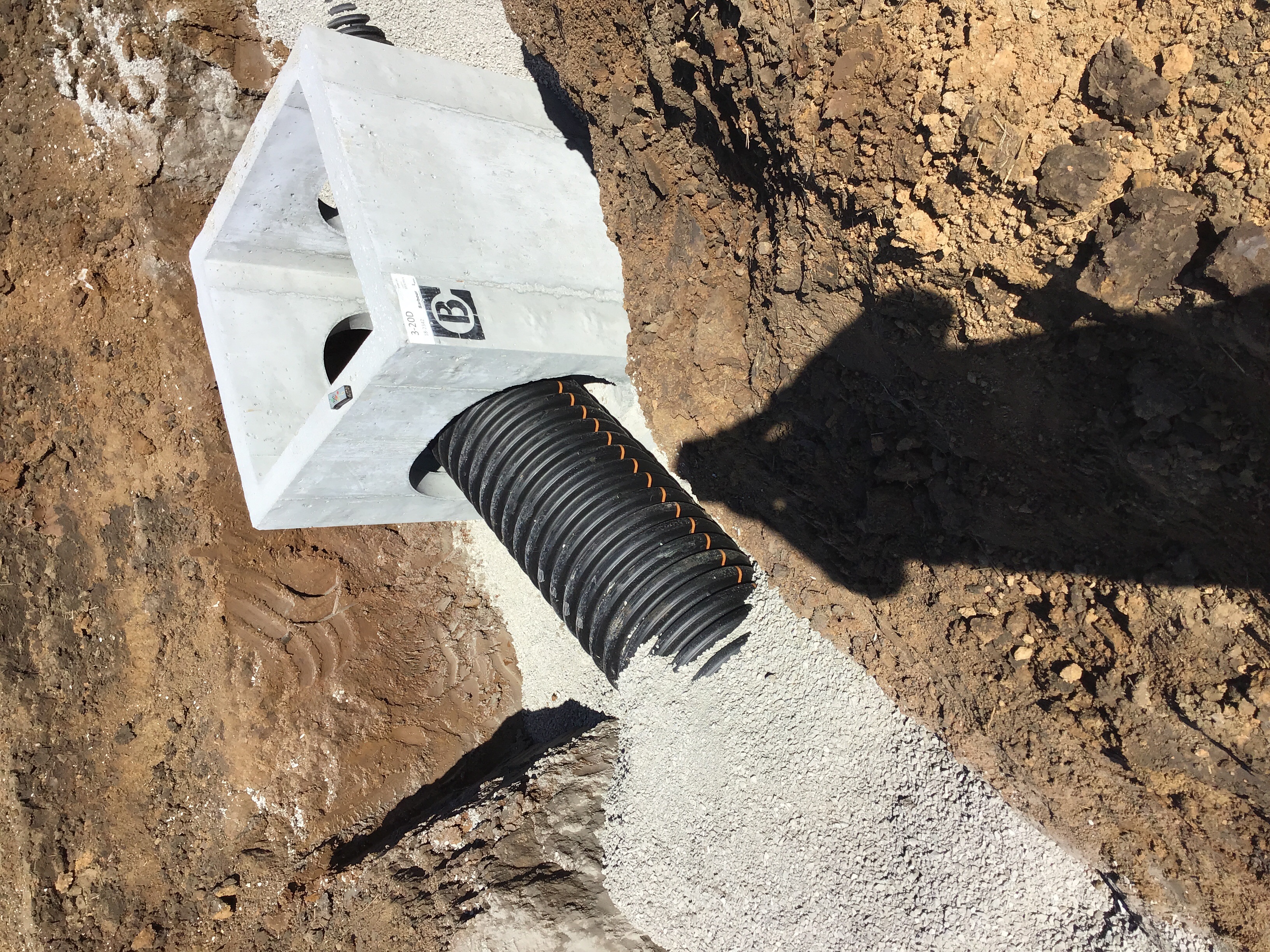

The Redford crew is working on the Storm sewer lines 3-10 & 3-30. The crew installed approximately 275’ ft of the 18”in HDPE and 81’ ft of the 15” in HDPE line for 3-10 from station 2+00.22 to 4+55.41 Curb inlets 3-10A, 3-10B, 3-10C, & 3-11A have been installed. The collars and inverts are poured. Photos are attached. The crew also installed line 3-30. Approximately 23’ft of the HDPE and 42’ft of the RCP have been installed from station 1+23.00 to 1+88.50 Curb inlets 3-30B and 3-30C have been installed. The collars and inverts have been poured. Photos are attached.
Storm Sewer Construction Inspection Partial 4/16/2019 04/16/2019
Misc
Informational
04/11/2019
The Redford crew is working on the Storm sewer lines 3-10 & 3-30. The crew installed approximately 275’ ft of the 18”in HDPE and 81’ ft of the 15” in HDPE line for 3-10 from station 2+00.22 to 4+55.41 Curb inlets 3-10A, 3-10B, 3-10C, & 3-11A have been installed. The collars and inverts are poured. Photos are attached. The crew also installed line 3-30. Approximately 23’ft of the HDPE and 42’ft of the RCP have been installed from station 1+23.00 to 1+88.50 Curb inlets 3-30B and 3-30C have been installed. The collars and inverts have been poured. Photos are attached.
Misc
Informational
04/16/2019
The RedFord crew is working on the storm sewer line 3-20. The crew installed the flared end section 3-20A. The junction boxes and curb inlets 3-20B, 3-20C & 3-20D have been installed. I inspected approximately 83’ft of the 30” RCP and 300’ft of the HDPE for this line from station 1+63.00 to approximately 5+50. Photos are attached. The crew plans to pour the collars this afternoon and the inverts at a later date.
Miscellaneous PWORKS Inspection Partial 04/17/2019
Misc
Partial Correction
04/17/2019
KC Testing Lab was on site performing the density and moisture testing for the sanitary lateral crossings under the roads. The moisture contents were too high. The crew is going to let the crossings dry out and resume testing at a later date.
Storm Sewer Construction Inspection Partial 4/17/2019 04/17/2019
Misc
Informational
04/16/2019
The Redford crew is working on the Storm sewer lines 3-10 & 3-30. The crew installed approximately 275’ ft of the 18”in HDPE and 81’ ft of the 15” in HDPE line for 3-10 from station 2+00.22 to 4+55.41 Curb inlets 3-10A, 3-10B, 3-10C, & 3-11A have been installed. The collars and inverts are poured. Photos are attached. The crew also installed line 3-30. Approximately 23’ft of the HDPE and 42’ft of the RCP have been installed from station 1+23.00 to 1+88.50 Curb inlets 3-30B and 3-30C have been installed. The collars and inverts have been poured. Photos are attached.
Misc
Informational
04/16/2019
The RedFord crew is working on the storm sewer line 3-20. The crew installed the flared end section 3-20A. The junction boxes and curb inlets 3-20B, 3-20C & 3-20D have been installed. I inspected approximately 83’ft of the 30” RCP and 300’ft of the HDPE for this line from station 1+63.00 to approximately 5+50. Photos are attached. The crew plans to pour the collars this afternoon and the inverts at a later date.
Misc
Informational
04/17/2019
Misc
Informational
04/17/2019

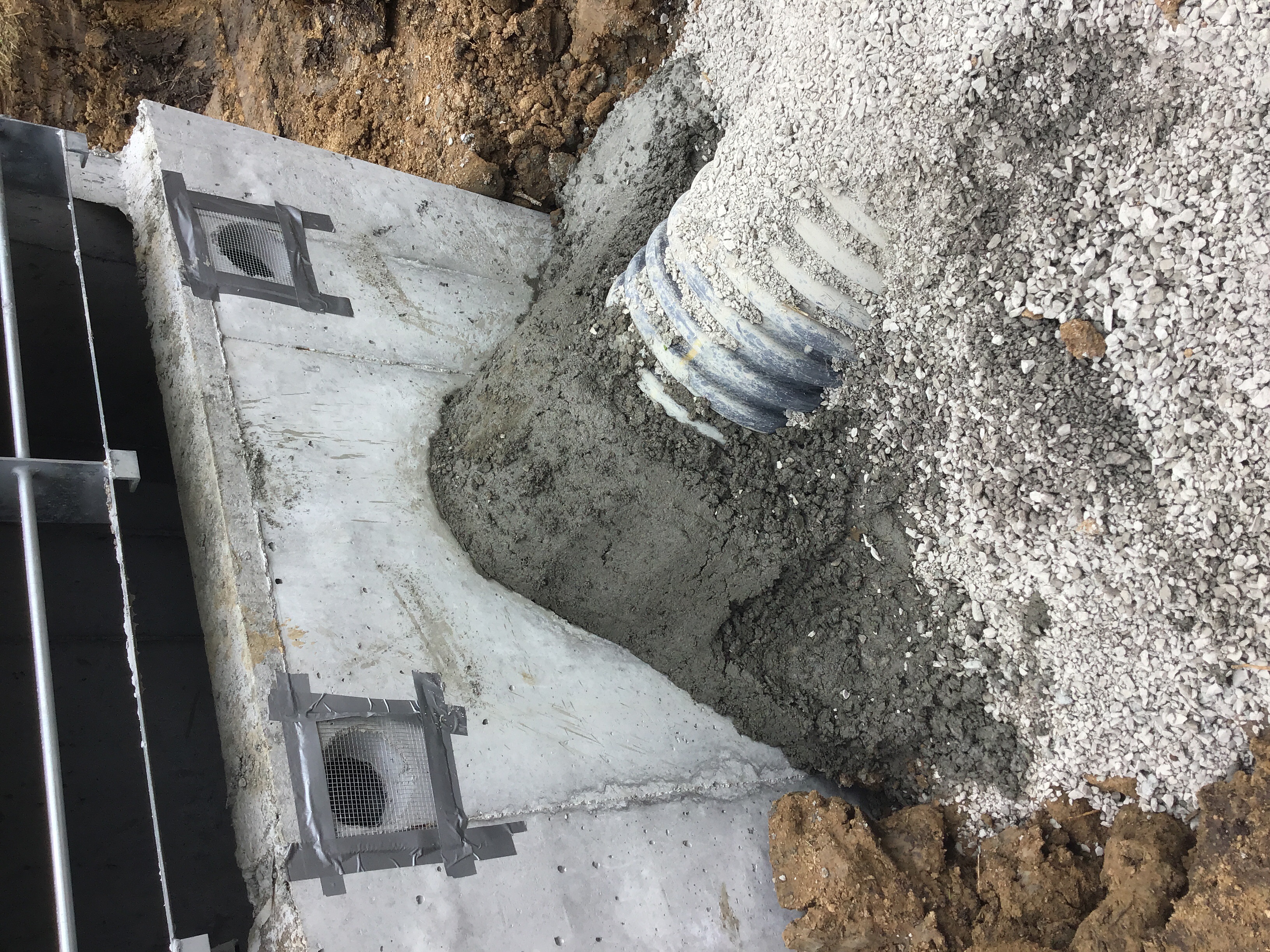

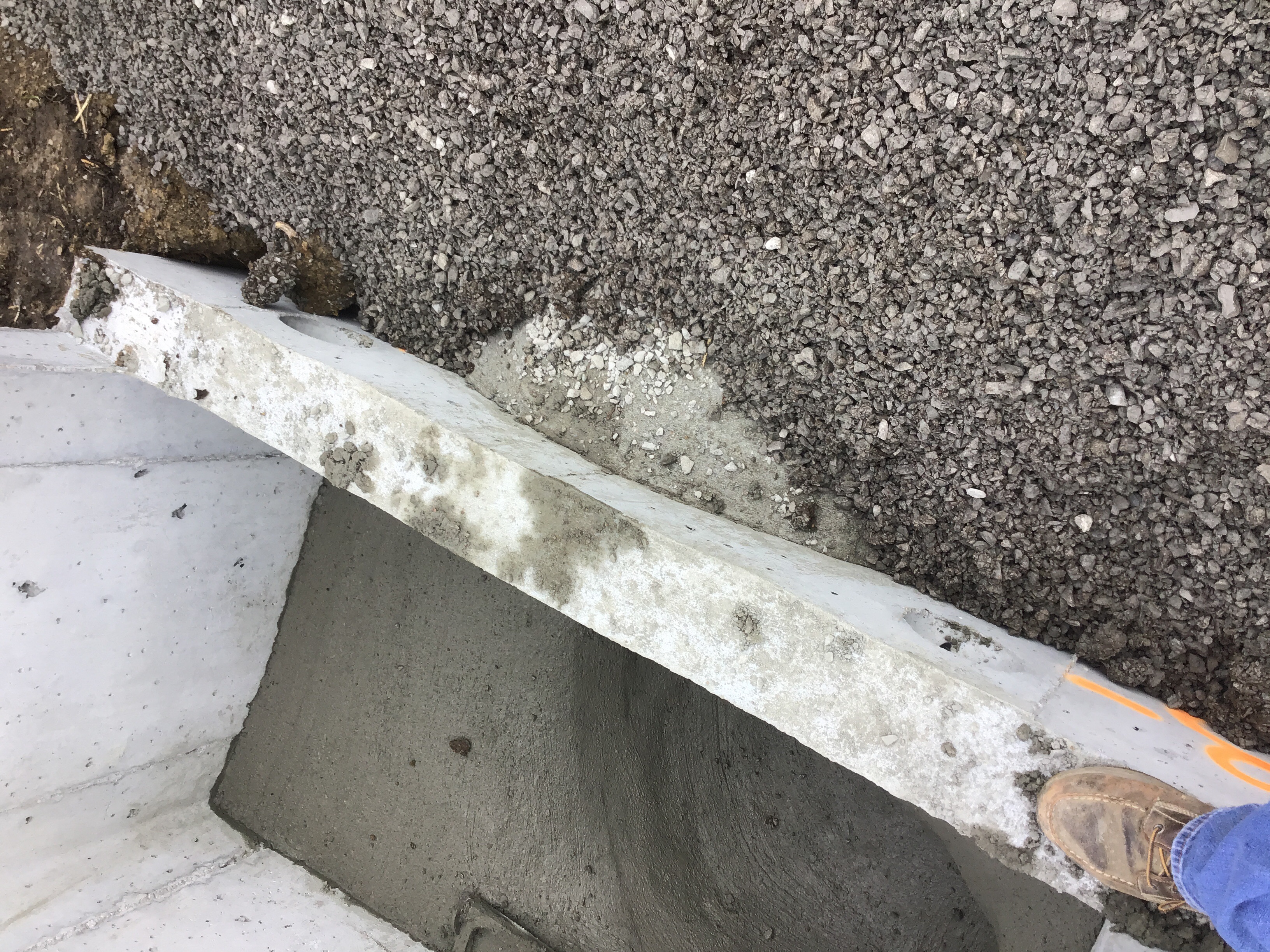

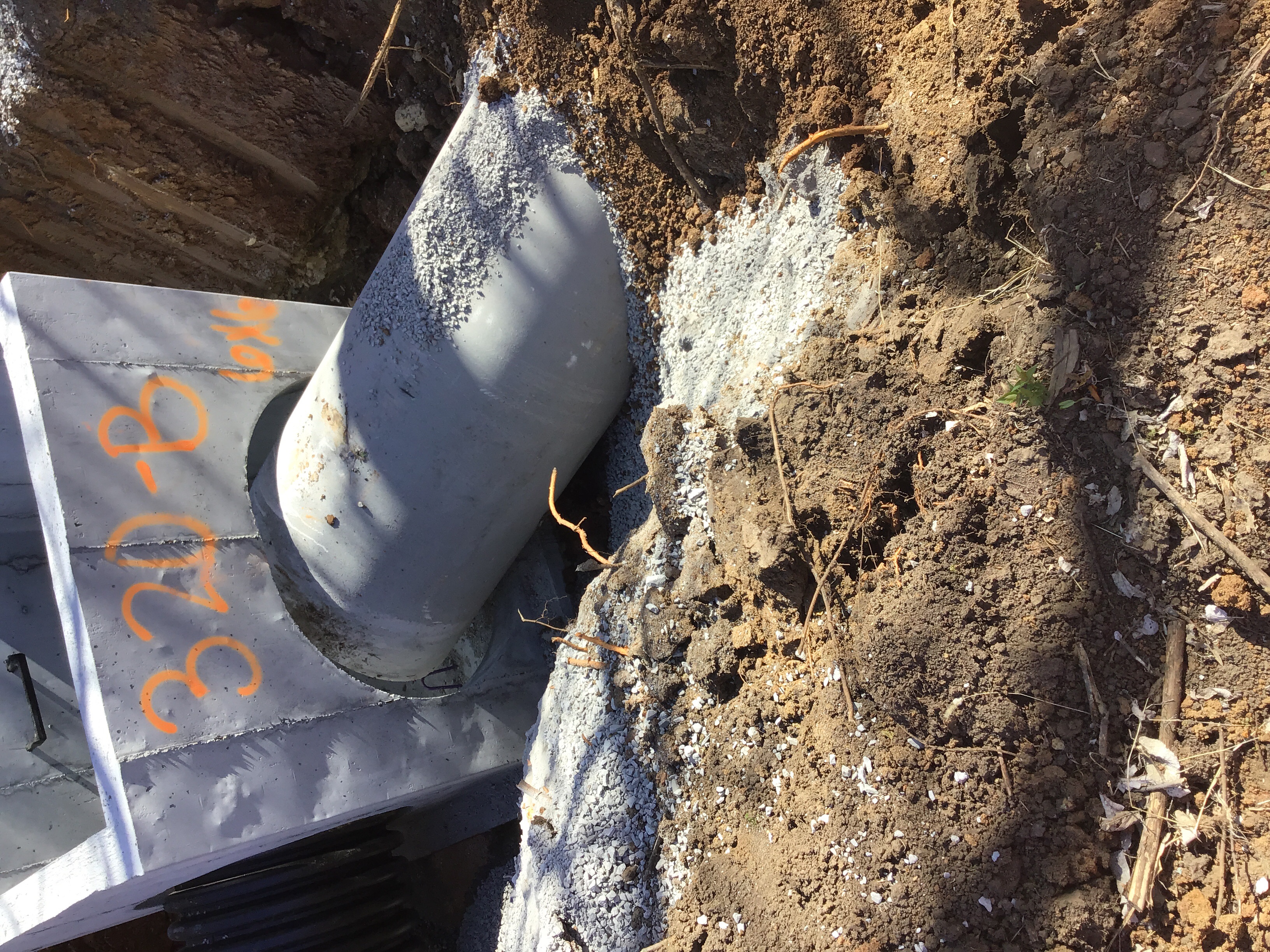

The Redford crew is installing the collars and inverts for storm lines 3-20 & 3-21 The crew installed the collar for junction box 3-21A. The inverts were poured for CI 3-20C, JB 3-20B, and JB 3-20D. Photos are attached.
Storm Sewer Construction Inspection Partial 04/22/2019
Misc
Informational
04/17/2019
The Redford crew is working on the Storm sewer lines 3-10 & 3-30. The crew installed approximately 275’ ft of the 18”in HDPE and 81’ ft of the 15” in HDPE line for 3-10 from station 2+00.22 to 4+55.41 Curb inlets 3-10A, 3-10B, 3-10C, & 3-11A have been installed. The collars and inverts are poured. Photos are attached. The crew also installed line 3-30. Approximately 23’ft of the HDPE and 42’ft of the RCP have been installed from station 1+23.00 to 1+88.50 Curb inlets 3-30B and 3-30C have been installed. The collars and inverts have been poured. Photos are attached.
Misc
Informational
04/17/2019
The RedFord crew is working on the storm sewer line 3-20. The crew installed the flared end section 3-20A. The junction boxes and curb inlets 3-20B, 3-20C & 3-20D have been installed. I inspected approximately 83’ft of the 30” RCP and 300’ft of the HDPE for this line from station 1+63.00 to approximately 5+50. Photos are attached. The crew plans to pour the collars this afternoon and the inverts at a later date.
Misc
Informational
04/17/2019
Misc
Informational
04/17/2019
The Redford crew is installing the collars and inverts for storm lines 3-20 & 3-21 The crew installed the collar for junction box 3-21A. The inverts were poured for CI 3-20C, JB 3-20B, and JB 3-20D. Photos are attached.
Misc
Informational
04/22/2019

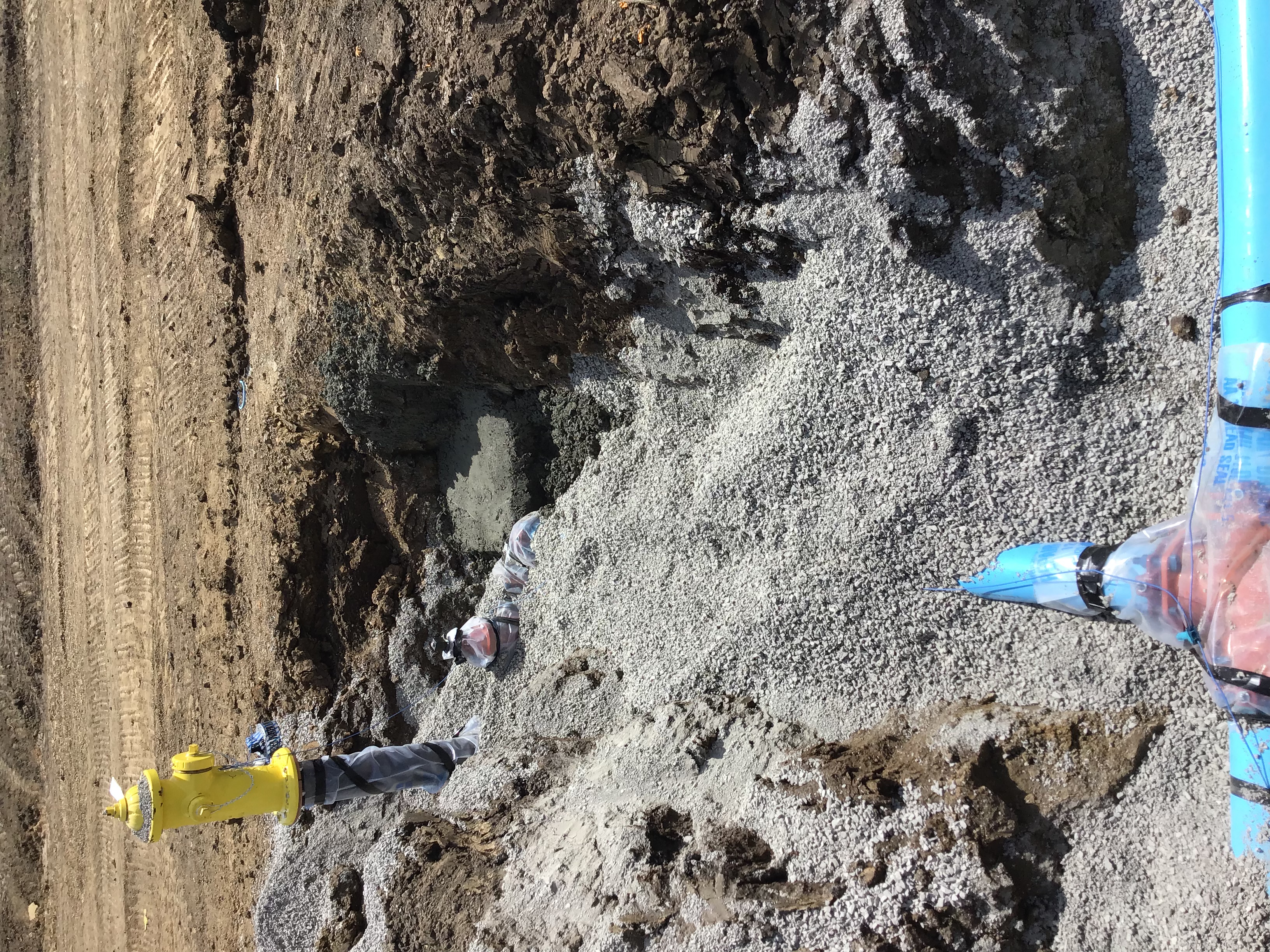

The Redford crew installed curb inlet boxes 3-21B and 3-21C and ran the HDPE between the boxes. The collars and inverts are poured. Photos are attached.
Sanitary Sewer - Air Test Passed 5/15/2019 05/15/2019
Misc
Informational
05/15/2019

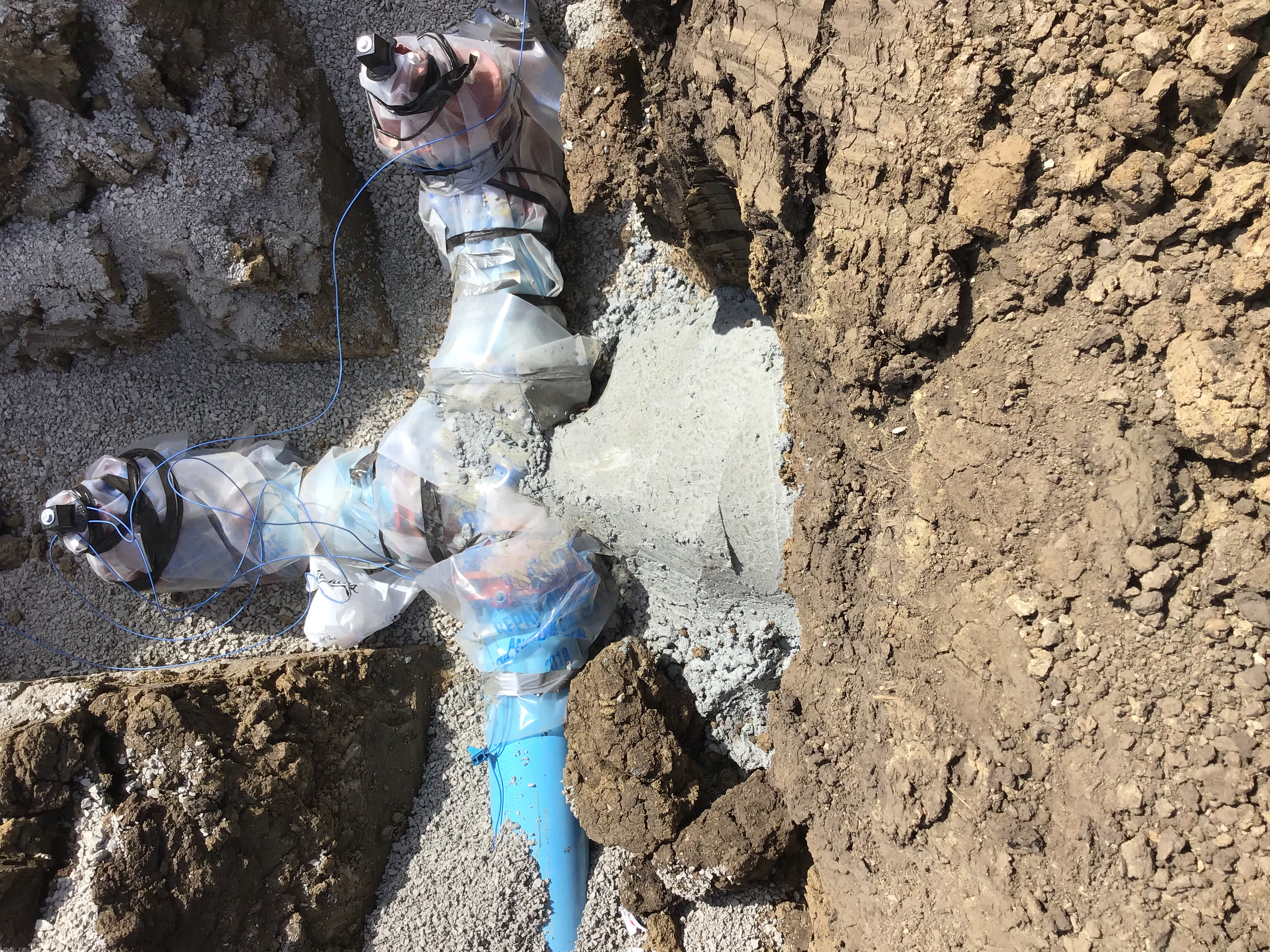

On site with the Redford crew testing both sanitary sewer lines 3-A & 3-B Sanitary Line 3-A: Line segment from station 2+74.51 to 4+30.70 Starting psi - 4 End psi - 4 Time - 7:34 Test Passed Line Segment from 4+30.70 to 5+86.54 Starting psi - 4 End psi - 4 Time - 7:34 Test Passed Line segment from 5+86.54 to 8+16.54 Starting psi - 4 End psi - 4 Time - 7:34 Test Passed Sanitary Line 3-B: Line segment from 2+75.64 to 3+06.16 Starting psi - 4 End psi - 3.75 Time - 7:34 Test Passed Line segment from 3+03.16 to 3+68.45 Starting psi - 4 End psi - 4 Time - 7:34 Test Passed Line segment from 3+68.45 to 5+91.71 Starting psi - 4 End psi - 4 Time 7:34 Test Passed Line segment from 5+91.71 to 7+11.79 Starting psi - 4 End psi - 4 Time - 7:34 Test Passed
Sanitary Sewer - Vacuum Passed 5/15/2019 05/15/2019
Misc
Informational
05/15/2019
On Site with the Redford crew to vacuum test the sanitary manholes for lines 3-A & 3-B Line 3-A: MH 3-A1 Is 11’ft deep and held at 10 with no drop for 2min and 30 seconds. Test Passed. MH 3-A2 is less than 10’ ft deep and dropped from 10 to 9.5 in 2 minutes. Test Passed. MH 3-A3 is less than 10’ft deep and dropped from 10 to 9.5 in 2 minutes. Test Passed. Line 3-B: MH 3-B2 is 10’ ft deep and held at 10 with no drop in 2 minutes. Test Passed. MH 3-B2 is 10’ft deep and held at 10 with no drop in 2 minutes. Test Passed. MH 3-3b is less than 10’ft deep and held at 10 for 2 minutes. Test Passed. MH 3-B4 is less than 10 ft deep and held at 10 for 2 minutes. Test Passed.
Sanitary Sewer - Mandrel Passed 5/15/2019 05/17/2019
Misc
Informational
05/17/2019

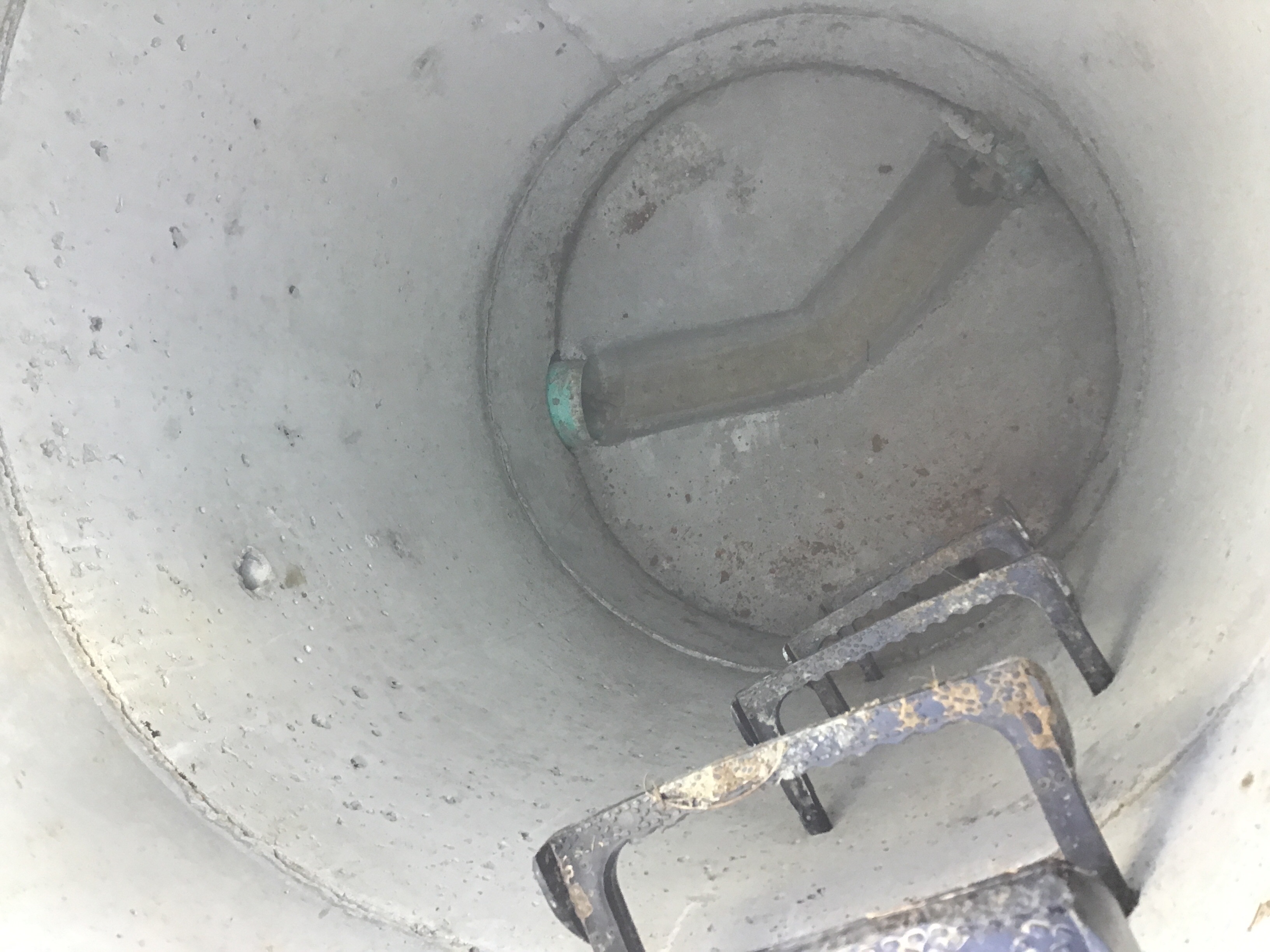

On site with the Redford crew for the mandrel test. I verified the mandrel was the correct size according to the city spec. I observed the mandrel pull through both sanitary sewer lines 3-A & 3-B with no deflection. Test Passed.
Water - Material Verification Passed 06/03/2019
Misc
Informational
06/03/2019
The water line materials appear to match the approved plans and meet City of Lee’s Summit’s standard design criteria and specs. Photos are attached.
Water Line - Construction Inspection Partial 06/03/2019
Misc
Informational
06/03/2019
The Redford crew is on site working on the Public Water line 3-02B. I inspected the install of the line segment from station 3+11.70 to the hydrant assembly at 1+46.50 KC testing is scheduled to be out upon completion of the water line install to test compaction of the road crossings. I will return today for further inspections.
Water Line - Construction Inspection Partial 6/3/2019 06/03/2019
Misc
Informational
06/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Water Line - Construction Inspection Partial 6/4/2019 06/04/2019
Misc
Informational
06/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/04/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Water Line - Construction Inspection Partial 6/4/2019 06/04/2019
Misc
Informational
06/04/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/04/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/04/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
06/04/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Water Line - Construction Inspection Partial 06/05/2019
Misc
Informational
06/04/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/04/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/04/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
06/04/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
06/05/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Water Line - Construction Inspection Partial 06/07/2019
Misc
Informational
06/05/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/05/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/05/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
06/05/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
06/05/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
06/07/2019

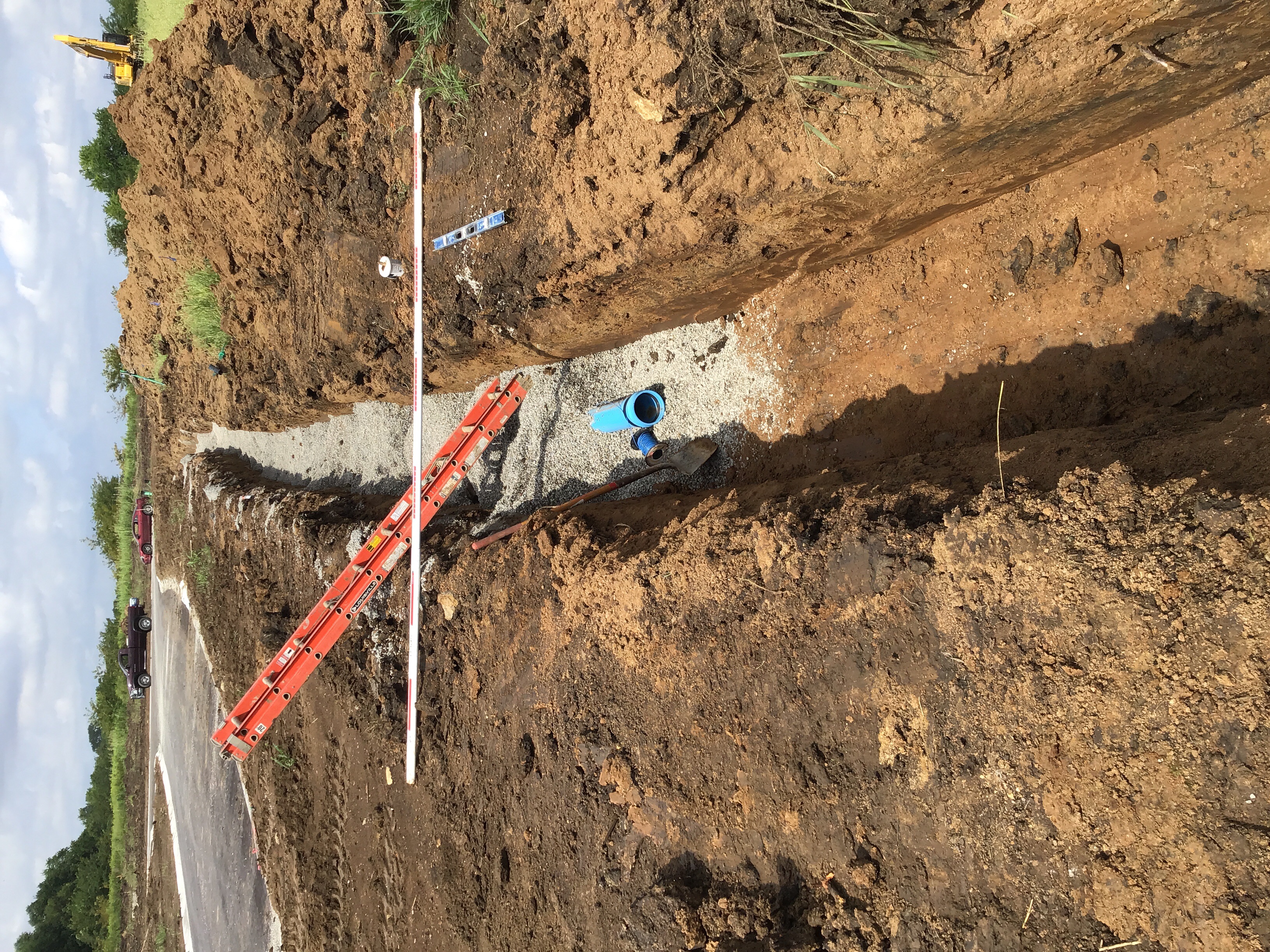

The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Pavement-Proof Roll Passed 7/19/2019 07/19/2019
Misc
Informational
07/19/2019
I observed the proof roll for the fly ash treated subgrade for the subdivision. I verified the correct truck type and load weight. The proof roll passed inspection.
Erosion Control Inspection Failed 07/22/2019
Misc
Corrective Action Required
07/22/2019
The silt fence along the west side of the property and the diversion berm along the south side appear to be installed according to the plans. The temporary sediment trap # 2 appears to be installed according to the plans. There are areas along the east side of the property that need to be corrected. There are low areas that still need self fence installed and the diversion berm needs to be corrected to properly direct flow into the trap.
Misc
Corrective Action Required
07/22/2019
PW-Devices for Erosion and Sediment Control
Corrective Action Required
07/22/2019
There are problems with the erosion control devices on your site.
PW-Erosion and Sediment Control
Corrective Action Required
07/22/2019
Your project is in violation of the Erosion and Sediment control policy. Silt fence or other acceptable erosion control devices need to be installed on site. There is a significant amount of silt and debris washing out along SW Kline Rd where the new street is going to be tied in and also along SW Morris Dr just north of the construction site. Please make corrections to the erosion control devices asap. Photos are attached to the permit.
Misc
Corrective Action Required
07/22/2019
UPDATE Thomas Hudgens with Redford Construction met me on site to discuss a solution and he plans to have a crew out asap to clean the washed out areas and get erosion control devices installed. I will update when the work is completed.
Curb - Proof Roll Passed 07/26/2019
Misc
Informational
07/26/2019
Randy Spalding Excavating performed the proof roll for the public street curbs. I verified that the tandem axle truck had a 20 ton load on it and the roll test passed inspection. The curb crew plans to start on Monday 7/29/19.
Public Curb Inspection Partial 7/29/2019 07/29/2019
Misc
Informational
07/29/2019
The JK Concrete crew is on site installing the public curbs for the subdivision. KC Testing is also on site performing the required testing of the concrete provided. I am collecting tickets and verifying the concrete type as well the materials and equipment used is in compliance. Copies of the concrete tickets, testing results and photos of the work performed will be uploaded into the system.
Misc
Informational
07/29/2019
The JK Concrete crew is on site installing the public curbs for the subdivision. KC Testing is also on site performing the required testing of the concrete provided. I am collecting tickets and verifying the concrete type as well the materials and equipment used is in compliance. Copies of the concrete tickets, testing results and photos of the work performed will be uploaded into the system.
Public Curb Inspection Partial 07/30/2019
Misc
Informational
07/29/2019
The JK Concrete crew is on site installing the public curbs for the subdivision. KC Testing is also on site performing the required testing of the concrete provided. I am collecting tickets and verifying the concrete type as well the materials and equipment used is in compliance. Copies of the concrete tickets, testing results and photos of the work performed will be uploaded into the system.
Misc
Informational
07/29/2019
The JK Concrete crew is on site installing the public curbs for the subdivision. KC Testing is also on site performing the required testing of the concrete provided. I am collecting tickets and verifying the concrete type as well the materials and equipment used is in compliance. Copies of the concrete tickets, testing results and photos of the work performed will be uploaded into the system.
Misc
Informational
07/30/2019
The JK Concrete crew is on site today continuing the public curb install for the subdivision. KC Testing is also on site performing the required testing of the concrete provided. I am collecting tickets and verifying the concrete type as well the materials and equipment used is in compliance. Copies of the concrete tickets, testing results and photos of the work performed will be uploaded into the system.
Erosion Control Inspection Passed 7/26/2019 07/31/2019
Misc
Resolved
07/31/2019
The silt fence along the west side of the property and the diversion berm along the south side appear to be installed according to the plans. The temporary sediment trap # 2 appears to be installed according to the plans. There are areas along the east side of the property that need to be corrected. There are low areas that still need self fence installed and the diversion berm needs to be corrected to properly direct flow into the trap.
Misc
Resolved
07/31/2019
PW-Devices for Erosion and Sediment Control
Resolved
07/31/2019
There are problems with the erosion control devices on your site.
PW-Erosion and Sediment Control
Resolved
07/31/2019
Your project is in violation of the Erosion and Sediment control policy. Silt fence or other acceptable erosion control devices need to be installed on site. There is a significant amount of silt and debris washing out along SW Kline Rd where the new street is going to be tied in and also along SW Morris Dr just north of the construction site. Please make corrections to the erosion control devices asap. Photos are attached to the permit.
PW-Erosion and Sediment Control
Informational
07/31/2019
Site was reviewed for compliance with erosion control specifications. The sediment basin was observed to be functioning properly with clean rock and standing water. Vegetation was established throughout the area with no visible signs of erosion leaving the site.
Pavement-Proof Roll Passed 08/01/2019
Misc
Informational
08/01/2019
The Randy Spalding crew performed the proof roll for the subdivision streets. I verified the correct truck and load weight. The roll test passed inspection.

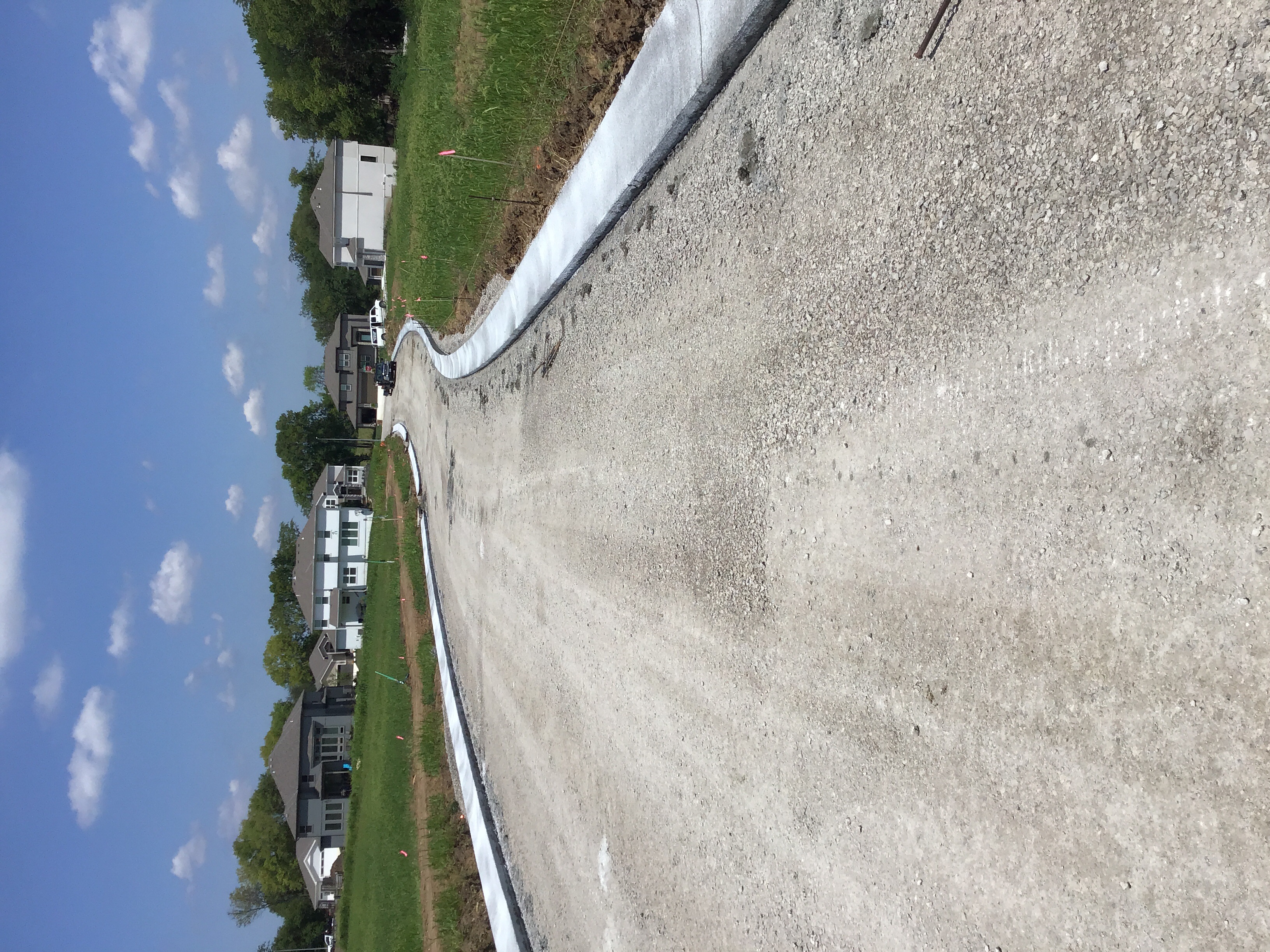

Pavement-Surface Partial 8/2/2019 08/02/2019
Misc
Informational
08/02/2019

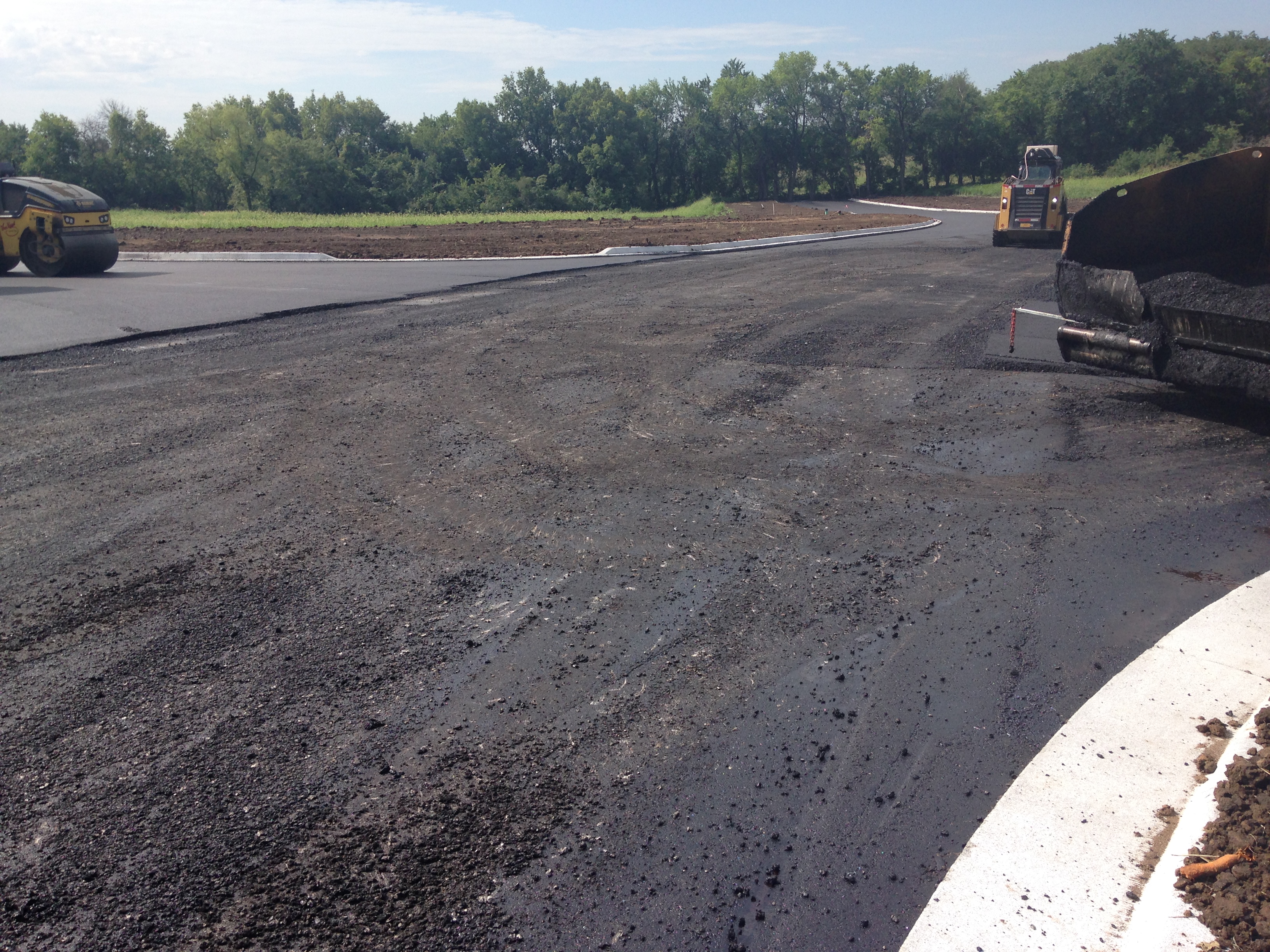

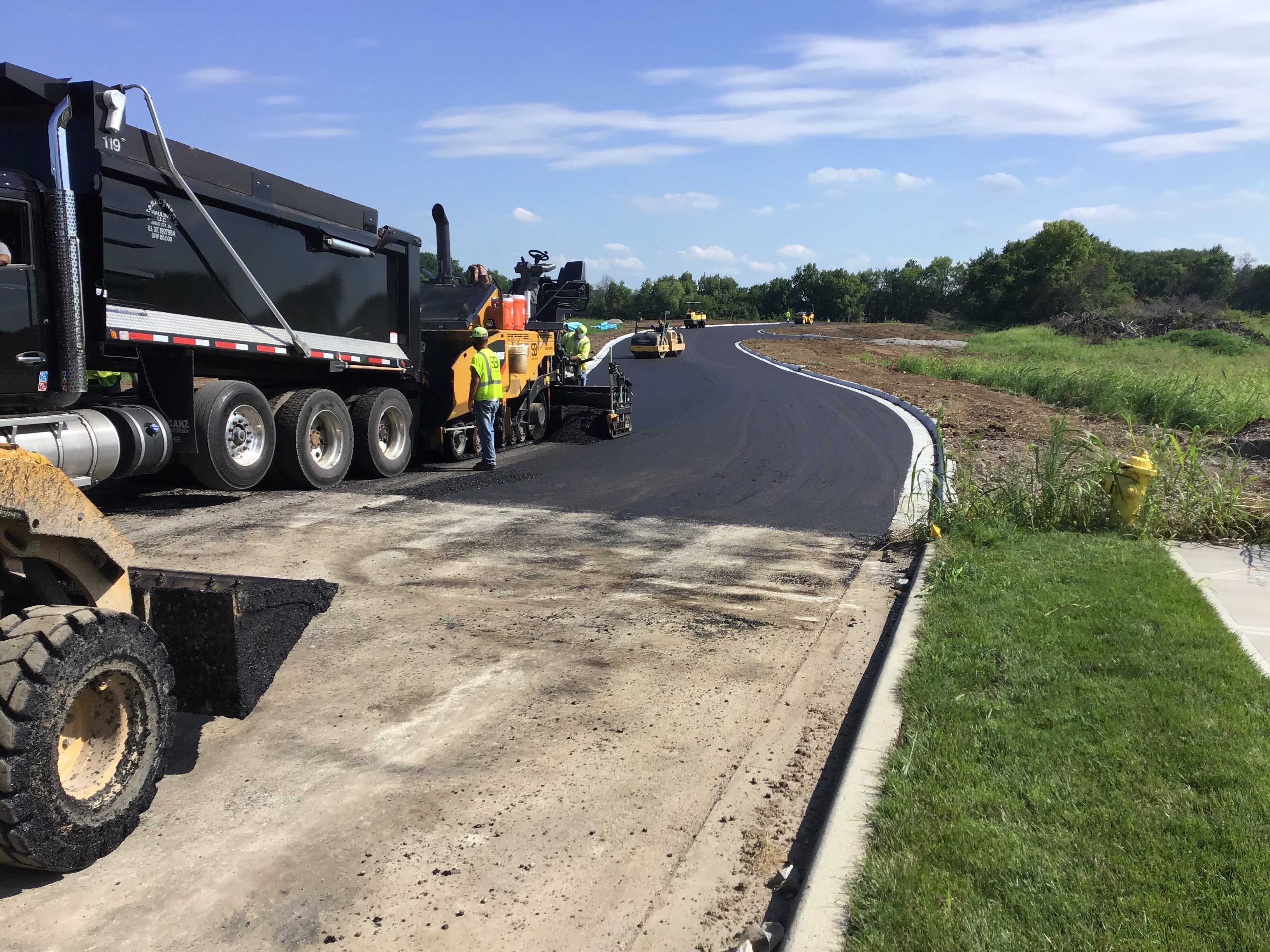

Superior Bowen is on site installing the base asphalt lift for the subdivision streets. I verified the correct asphalt mix type and temperature. The materials and equipment being used for the install is approved by the city standards.
Street - Surface Course Partial 8/3/2019 at 1:00 PM 08/03/2019
Misc
Informational
08/03/2019

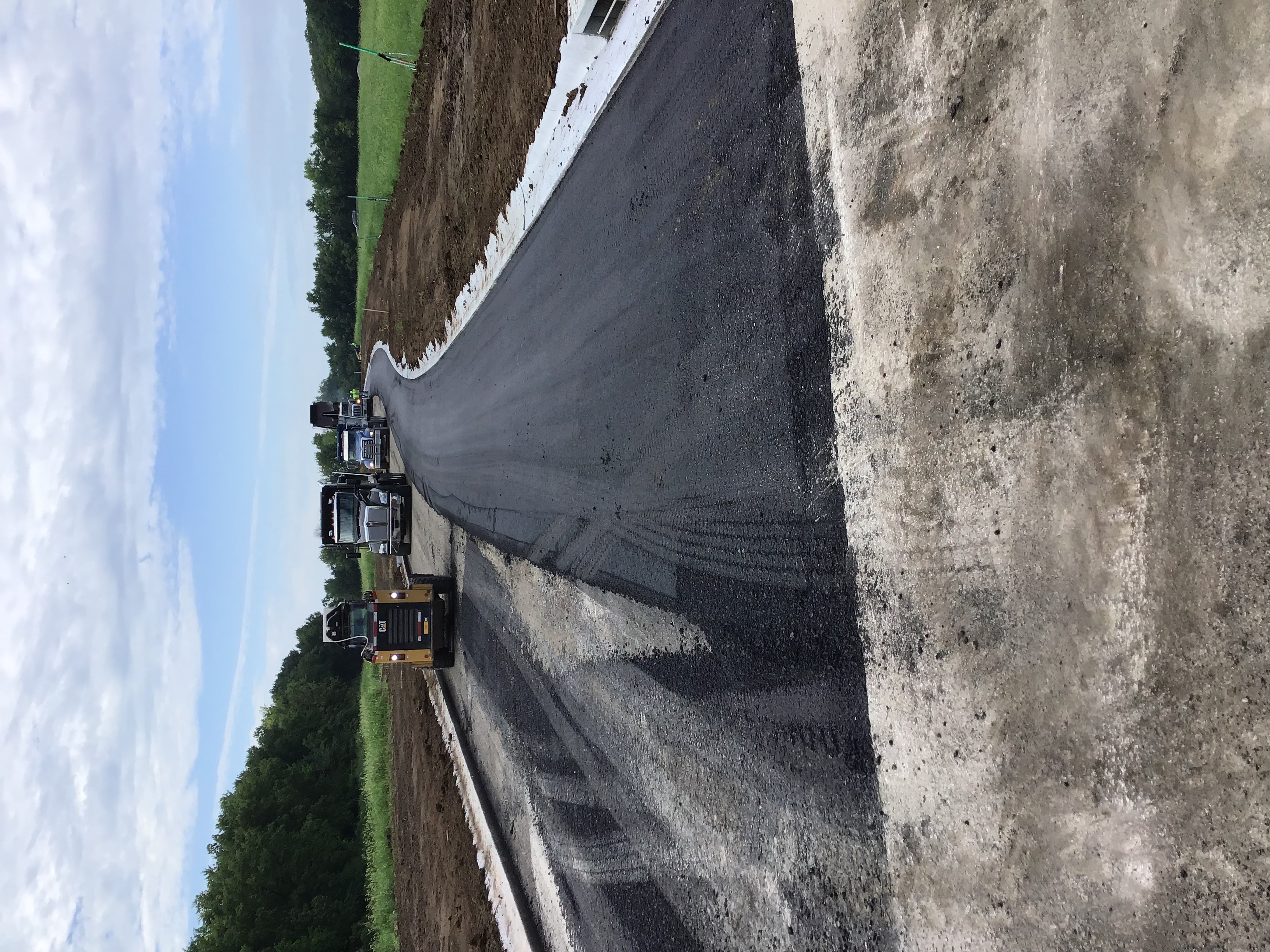

Superior Bowen Asphalt Company laid 1,055 tons of APWA Type 5 V asphalt for the surface lift of the divisions streets. Still need to check pedestrian crossings for ADA requirements. RP 8-3-19
Street - Wedge Lift Passed 8/3/2019 at 10:30 AM 08/03/2019
Misc
Informational
08/03/2019
Superior Bowen Asphalt Company laid 523 tons of APWA Type 5 R asphalt for the wedge lift on the subdivisions streets. RP 8-3-19
Misc
Informational
08/03/2019
Superior Bowen Asphalt Company laid 523 tons of APWA Type 5 R asphalt for the wedge lift on the subdivisions streets. RP 8-3-19
Pavement-Surface Passed 8/3/2019 at 8:00 AM 08/03/2019
Misc
Informational
08/02/2019
Superior Bowen is on site installing the base asphalt lift for the subdivision streets. I verified the correct asphalt mix type and temperature. The materials and equipment being used for the install is approved by the city standards.
Misc
Informational
08/03/2019
Superior Bowen Asphalt Company laid 215 tons of APWA Type 5 R asphalt for the base lift of the subdivisions streets. RP 8-3-19
ADA Inspection Partial 08/19/2019
Misc
Informational
08/19/2019
The JK Concrete crew is on site installing the ADA Ramp sections of the project. There appears to be sufficient compacted aggregate. I will return at a later date for a post pour inspection.
Water Line - Construction Inspection Partial 6/10/2019 08/20/2019
Misc
Informational
06/07/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/07/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
06/07/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
06/07/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
06/07/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
06/07/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/20/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Storm Sewer Construction Inspection Partial 08/20/2019
Misc
Informational

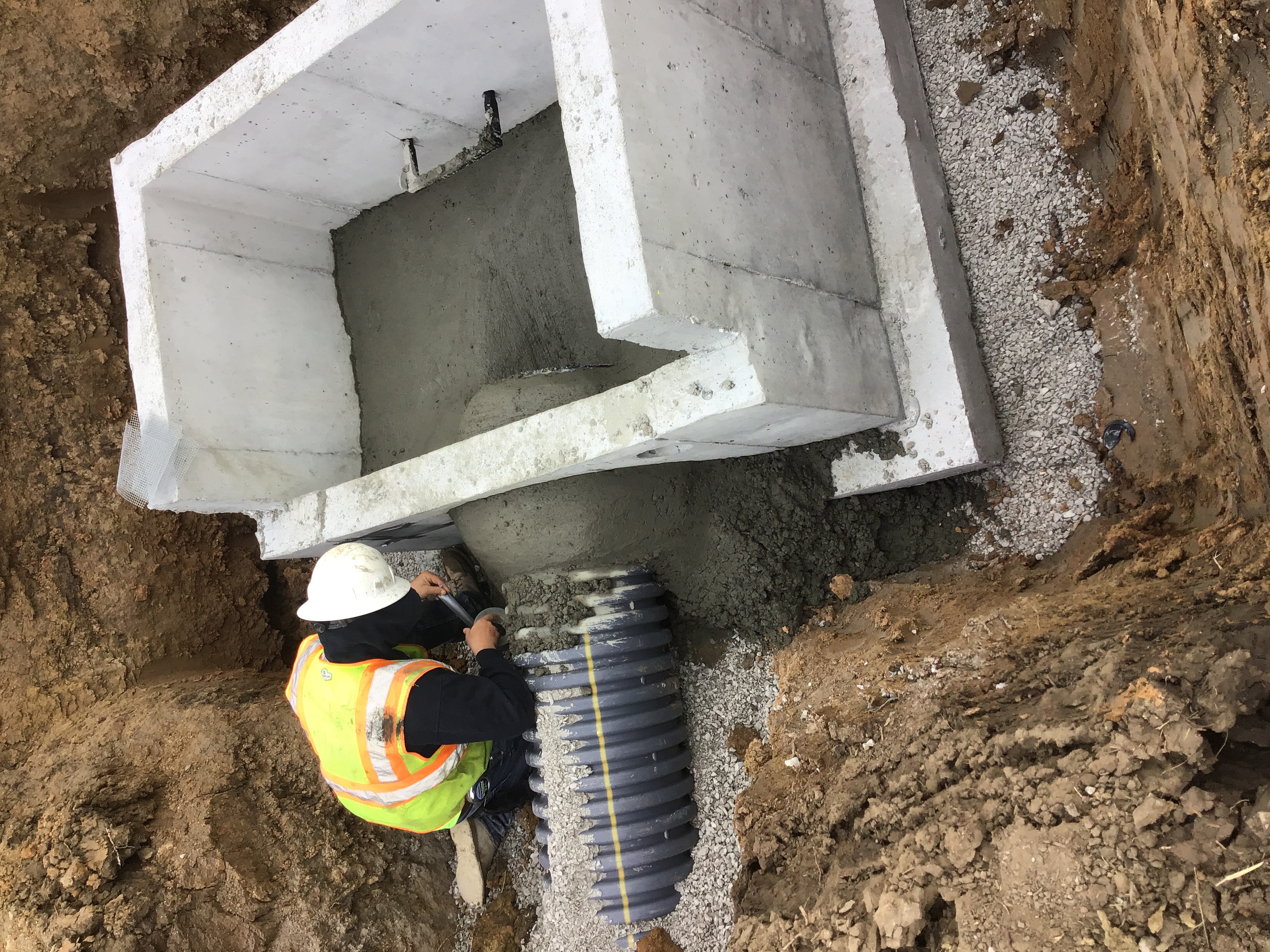

08/20/2019

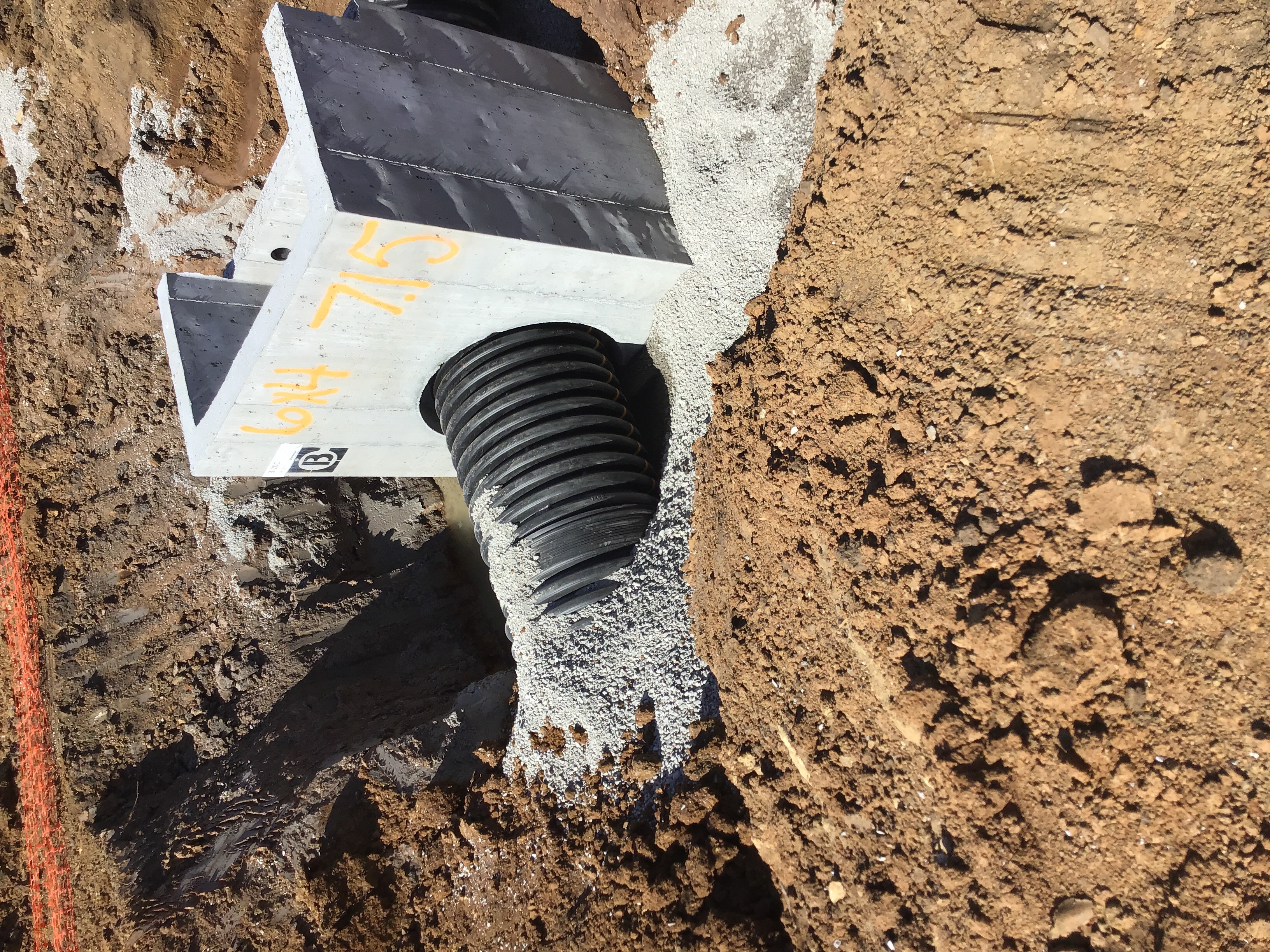

The revised storm line 3-40 plans were delivered to Redford Construction. The contractor was on site yesterday 8/19/19 clearing trees for in preparation for the revised storm line install.
Water Line - Construction Inspection Partial 8/20/2019 08/21/2019
Misc
Informational
08/20/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/20/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/20/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
08/20/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
08/20/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
08/20/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/20/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
08/21/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Water Line - Construction Inspection Partial 08/23/2019
Misc
Informational
08/21/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/21/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/21/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
08/21/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
08/21/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
08/21/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/21/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
08/21/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
08/23/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Erosion Control Inspection Failed 7/23/2019 08/27/2019
Misc
Corrective Action Required
07/22/2019
The silt fence along the west side of the property and the diversion berm along the south side appear to be installed according to the plans. The temporary sediment trap # 2 appears to be installed according to the plans. There are areas along the east side of the property that need to be corrected. There are low areas that still need self fence installed and the diversion berm needs to be corrected to properly direct flow into the trap.
Misc
Corrective Action Required
07/22/2019
PW-Devices for Erosion and Sediment Control
Corrective Action Required
07/22/2019
There are problems with the erosion control devices on your site.
PW-Erosion and Sediment Control
Corrective Action Required
07/22/2019
Your project is in violation of the Erosion and Sediment control policy. Silt fence or other acceptable erosion control devices need to be installed on site. There is a significant amount of silt and debris washing out along SW Kline Rd where the new street is going to be tied in and also along SW Morris Dr just north of the construction site. Please make corrections to the erosion control devices asap. Photos are attached to the permit.
Misc
Corrective Action Required
07/22/2019
UPDATE Thomas Hudgens with Redford Construction met me on site to discuss a solution and he plans to have a crew out asap to clean the washed out areas and get erosion control devices installed. I will update when the work is completed.
PW-Devices for Erosion and Sediment Control
Corrective Action Required
08/27/2019
There are problems with the erosion control devices on your site. ESC devices need to be installed along the roadway especially in the lower lying areas. The gutter buddies are starting to fill in with silt due to the heavy rain event and need cleaned out and maintained. Please make corrections promptly to the ESC devices to avoid any work stoppage.
Water Line - Construction Inspection Partial 8/23/2019 08/27/2019
Misc
Informational
08/23/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/23/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/23/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
08/23/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
08/23/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
08/23/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/23/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
08/23/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
08/23/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
08/27/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Water Line - Construction Inspection Partial 08/29/2019
Misc
Informational
08/27/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/27/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/27/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
08/27/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
08/27/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
08/27/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/27/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
08/27/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
08/27/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
08/27/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
08/29/2019

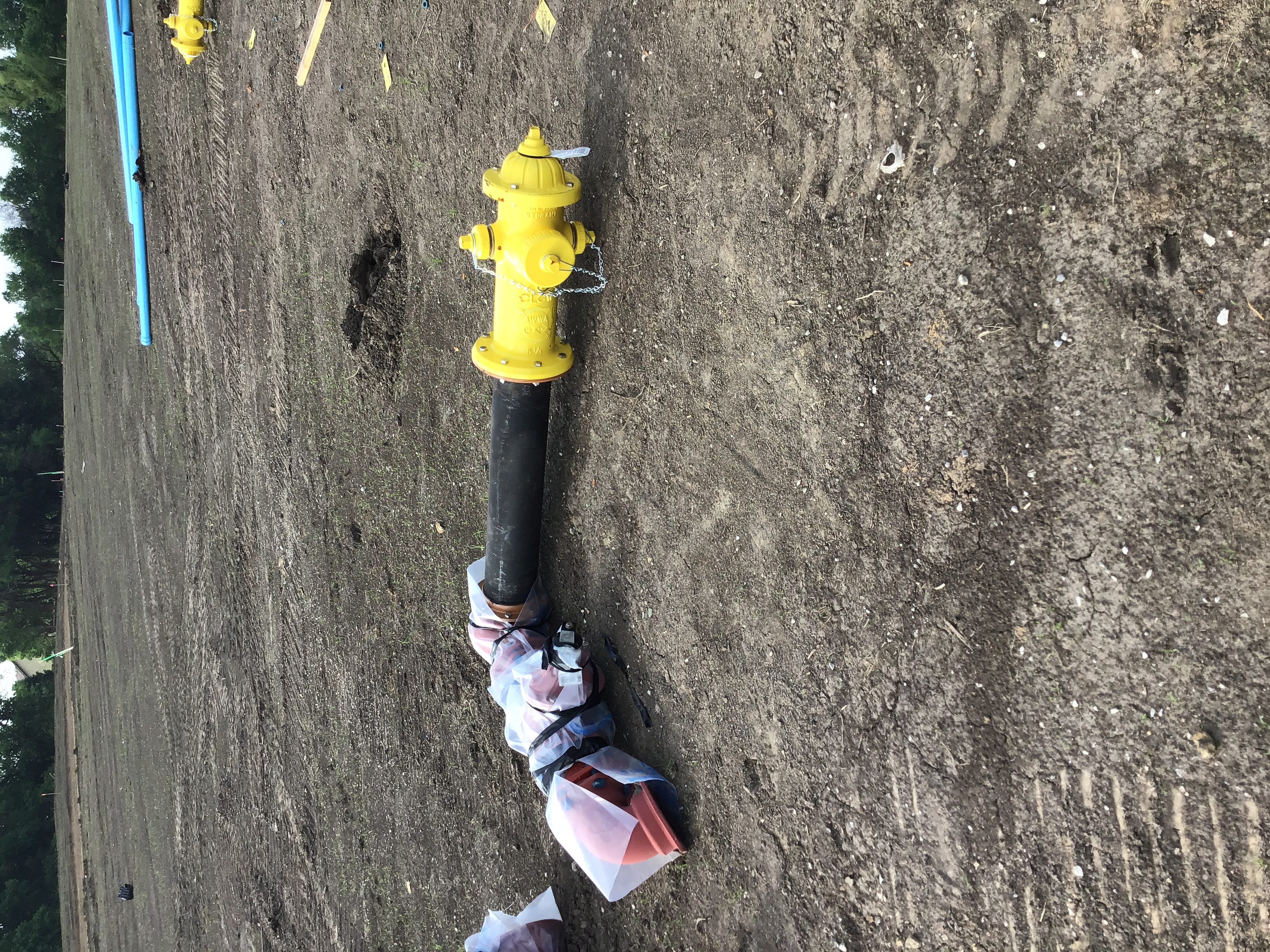

The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Water Line - Construction Inspection Partial 09/03/2019
Misc
Informational
08/29/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/29/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
08/29/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
08/29/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
08/29/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
08/29/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
08/29/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
08/29/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
08/29/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
08/29/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
08/29/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/03/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Water Line - Construction Inspection Partial 09/03/2019
Misc
Informational
09/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/03/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
09/03/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
09/03/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
09/03/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
09/03/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
09/03/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
09/03/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
09/03/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
09/03/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/03/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Misc
Informational
09/03/2019
The Redford crew installed the section of water line along SW Kline Ave where the existing blow off assembly was to be removed, station 5+89.09 The water line along this section was moved slightly with in the right of way to avoid intersecting with a large tree and other utilities in the way. The deviation will be drawn to reflect changes in the As Built drawings.
Water Line - Construction Inspection Partial 09/05/2019
Misc
Informational
09/03/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
09/03/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
09/03/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
09/03/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
09/03/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
09/03/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/03/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Misc
Informational
09/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/03/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/03/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
09/03/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
09/03/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
09/03/2019
The Redford crew installed the section of water line along SW Kline Ave where the existing blow off assembly was to be removed, station 5+89.09 The water line along this section was moved slightly with in the right of way to avoid intersecting with a large tree and other utilities in the way. The deviation will be drawn to reflect changes in the As Built drawings.
Misc
Informational
09/05/2019
The City of Lee’s Summit Water Utilities Dept. was on site installing the construction taps in preparation for the water line chlorination.
Storm Sewer Construction Inspection Partial 09/05/2019
Misc
Informational
04/22/2019
The Redford crew is working on the Storm sewer lines 3-10 & 3-30. The crew installed approximately 275’ ft of the 18”in HDPE and 81’ ft of the 15” in HDPE line for 3-10 from station 2+00.22 to 4+55.41 Curb inlets 3-10A, 3-10B, 3-10C, & 3-11A have been installed. The collars and inverts are poured. Photos are attached. The crew also installed line 3-30. Approximately 23’ft of the HDPE and 42’ft of the RCP have been installed from station 1+23.00 to 1+88.50 Curb inlets 3-30B and 3-30C have been installed. The collars and inverts have been poured. Photos are attached.
Misc
Informational
04/22/2019
The RedFord crew is working on the storm sewer line 3-20. The crew installed the flared end section 3-20A. The junction boxes and curb inlets 3-20B, 3-20C & 3-20D have been installed. I inspected approximately 83’ft of the 30” RCP and 300’ft of the HDPE for this line from station 1+63.00 to approximately 5+50. Photos are attached. The crew plans to pour the collars this afternoon and the inverts at a later date.
Misc
Informational
04/22/2019
Misc
Informational
04/22/2019
The Redford crew is installing the collars and inverts for storm lines 3-20 & 3-21 The crew installed the collar for junction box 3-21A. The inverts were poured for CI 3-20C, JB 3-20B, and JB 3-20D. Photos are attached.
Misc
Informational
04/22/2019
The Redford crew installed curb inlet boxes 3-21B and 3-21C and ran the HDPE between the boxes. The collars and inverts are poured. Photos are attached.
Misc
Informational
09/05/2019
The Redford crew is on site starting on the revised storm sewer install for the existing north sediment pond. I will return this afternoon for further inspection and upload photos to the system.
Storm Sewer Construction Inspection Partial 09/05/2019
Misc
Informational
09/05/2019

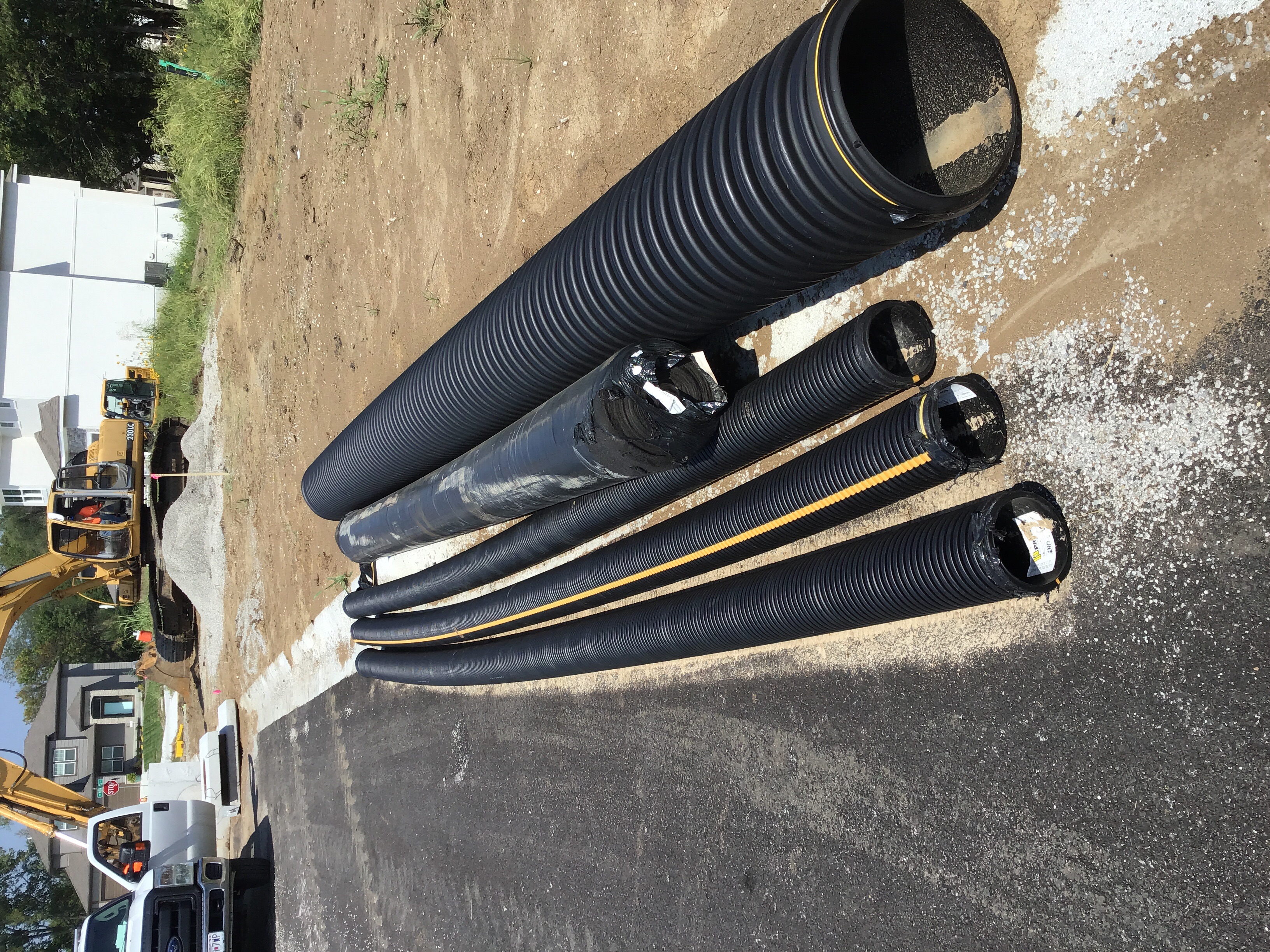

The revised storm line 3-40 plans were delivered to Redford Construction. The contractor was on site yesterday 8/19/19 clearing trees for in preparation for the revised storm line install.
Misc
Informational
09/05/2019
The Redford crew cut into the existing storm inlet in the back of the residents yard and set the pipe from the existing inlet to the new field inlet. The install appears to match the approved plans and the materials and methods used meet the criteria. The crew plans to pour the collars and inverts for the two boxes today around 4:00 pm. Ive uploaded current progress photos to the system. I will return for further inspection of the concrete work and install tomorrow.
ADA Inspection Passed 8/22/2019 09/06/2019
Misc
Informational
08/19/2019
The JK Concrete crew is on site installing the ADA Ramp sections of the project. There appears to be sufficient compacted aggregate. I will return at a later date for a post pour inspection.
Storm Sewer Construction Inspection Partial 9/6/2019 09/06/2019
Misc
Informational
09/05/2019
The revised storm line 3-40 plans were delivered to Redford Construction. The contractor was on site yesterday 8/19/19 clearing trees for in preparation for the revised storm line install.
Misc
Informational
09/05/2019
The Redford crew cut into the existing storm inlet in the back of the residents yard and set the pipe from the existing inlet to the new field inlet. The install appears to match the approved plans and the materials and methods used meet the criteria. The crew plans to pour the collars and inverts for the two boxes today around 4:00 pm. Ive uploaded current progress photos to the system. I will return for further inspection of the concrete work and install tomorrow.
Misc
Informational
09/06/2019
Collars and inverts were poured yesterday. The crew is backfilling the install an grading the swale area of the design at this time. Photos are uploaded to the system.
Water Line - Hydrostatic Test Passed 9/9/2019 09/09/2019
Misc
Informational

09/09/2019
The Redford Construction crew performed the hydro test for the public water main. I observed the gauge hold at 150 psi for two hours. The test passed. The crew plans to chlorinate the line either tomorrow or Wednesday 9/11/19.
Water Line - Construction Inspection Partial 9/13/2019 09/13/2019
Misc
Informational
09/05/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
09/05/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
09/05/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
09/05/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
09/05/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
09/05/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/05/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Misc
Informational
09/05/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/05/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/05/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
09/05/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
09/05/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
09/05/2019
The Redford crew installed the section of water line along SW Kline Ave where the existing blow off assembly was to be removed, station 5+89.09 The water line along this section was moved slightly with in the right of way to avoid intersecting with a large tree and other utilities in the way. The deviation will be drawn to reflect changes in the As Built drawings.
Misc
Informational
09/05/2019
The City of Lee’s Summit Water Utilities Dept. was on site installing the construction taps in preparation for the water line chlorination.
Misc
Informational
09/13/2019
Daniel with Redford Construction chlorinated the water main. The line will sit over the weekend and the crew plans to flush on Monday prior to taking a water sample.
Water Line - Construction Inspection Partial 09/16/2019
Misc
Informational
09/13/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
09/13/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
09/13/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
09/13/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
09/13/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
09/13/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/13/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Misc
Informational
09/13/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/13/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/13/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
09/13/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
09/13/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
09/13/2019
The Redford crew installed the section of water line along SW Kline Ave where the existing blow off assembly was to be removed, station 5+89.09 The water line along this section was moved slightly with in the right of way to avoid intersecting with a large tree and other utilities in the way. The deviation will be drawn to reflect changes in the As Built drawings.
Misc
Informational
09/13/2019
The City of Lee’s Summit Water Utilities Dept. was on site installing the construction taps in preparation for the water line chlorination.
Misc
Informational
09/13/2019
Daniel with Redford Construction chlorinated the water main. The line will sit over the weekend and the crew plans to flush on Monday prior to taking a water sample.
Misc
Informational
09/16/2019
Daniel with Redford construction flushed the water line of the chlorine. I verified the chlorine strips read the correct residue amount. They plan to take a day 1 sample tomorrow to the lab.
Water Line - Coliform Test 1 Partial 9/17/2019 09/17/2019
Misc
Informational
09/17/2019

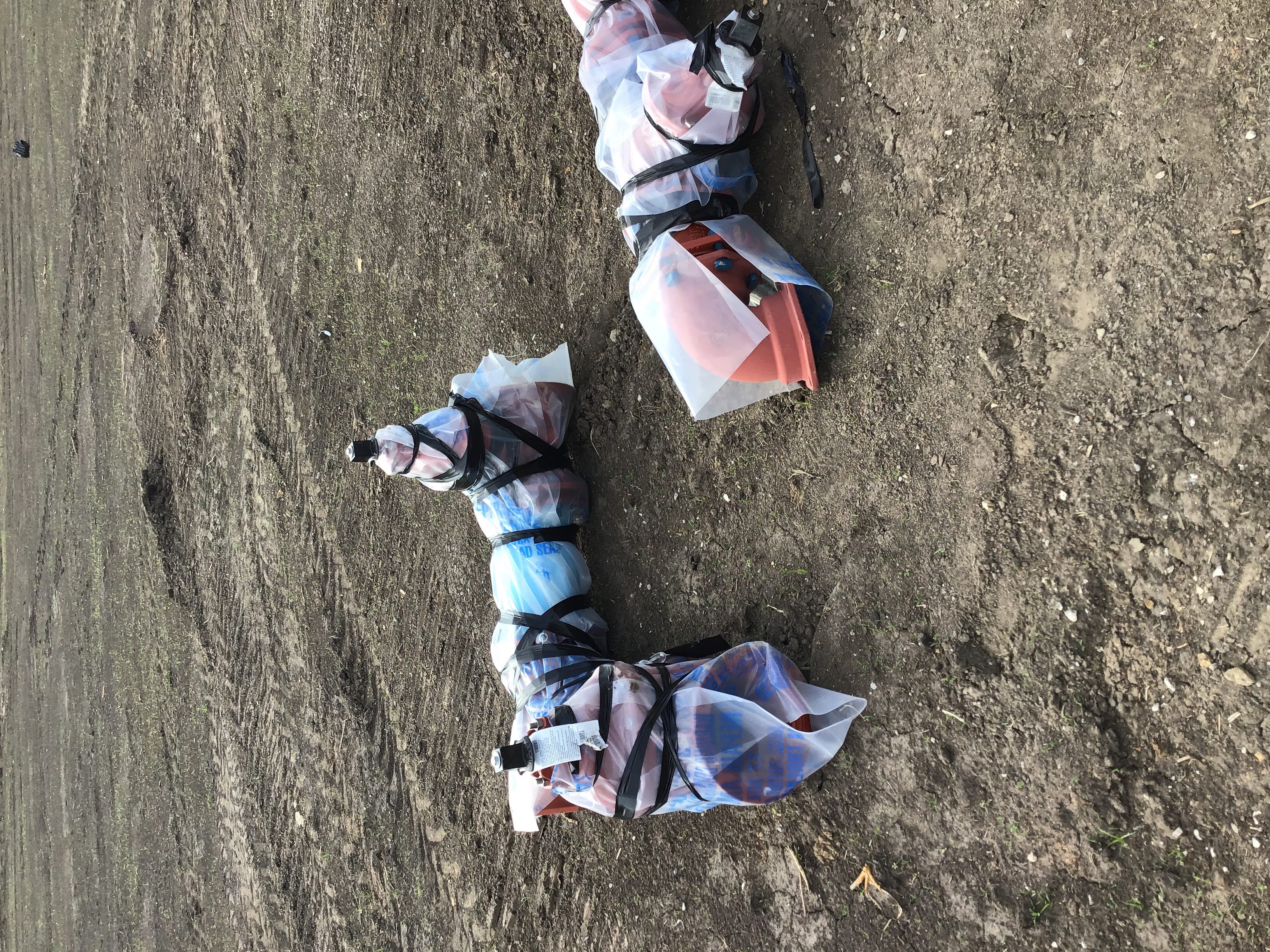

On site with Daniel from Redford Construction. We collected the day 1 samples for the water line and delivered them to Keystone Labs. We will know the results is 24 hours.
Water Line - Coliform Test 2 Partial 9/18/2019 09/18/2019
Misc
Informational
09/18/2019
I met Daniel with Redford Construction on site and collected the day 2 water samples for the site. I delivered the samples to Keystone Lab. We will know the results in 24 hours.
Water Line - Coliform Test 1 Passed 09/20/2019
Misc
Informational
09/17/2019
On site with Daniel from Redford Construction. We collected the day 1 samples for the water line and delivered them to Keystone Labs. We will know the results is 24 hours.
Misc
Informational
09/20/2019
The day 1 bacteria samples passed. The results from Keystone Labs are uploaded into the system.
Water Line - Coliform Test 2 Passed 09/20/2019
Misc
Informational
09/18/2019
I met Daniel with Redford Construction on site and collected the day 2 water samples for the site. I delivered the samples to Keystone Lab. We will know the results in 24 hours.
Misc
Informational
09/20/2019
The day 2 bacteria samples passed. The results from Keystone Labs are uploaded into the system.
Water Line - Construction Inspection Passed 09/20/2019
Misc
Informational
09/16/2019
The Redford crew is installing the 8” water main line 3-03A. I inspected the line from station 3+85.11 to approximately 5+00 and it appears to match the approved plans and meet the City standard specs. The crew is also pouring the thrust and restrain blocks this morning. Photos are attached.
Misc
Informational
09/16/2019
The Redford Construction crew is on site to start the water line main for the subdivision. The road crossings were installed earlier this year and the crew is now working on the main. The crew has the tie in location exposed and is preparing to lay the first stick of pipe. I will return later today for further inspection.
Misc
Informational
09/16/2019
On 8/20/19 the Redford Construction crew installed the water line 3-01 from station 1+00 to approx 5+00. The crew is on site now continuing the line 3-01 install. Photos of the progress are uploaded.
Misc
Informational
09/16/2019
The Redford crew is installing water lines 3-03A & 3-03B. Line A is run from approx station 3+85.11 to the end of line. I verified that the install matches the plans and the the correct materials were used. Line B is run from approx station 1+00 to 3+69.36 I verified the correct materials and bury depth and that the install appears to match the plans. Photos of the work are uploaded.
Misc
Informational
09/16/2019
The Redford crew is working on the water line 3-03B. The crew is setting the hydrant assembly at the end of the line. I verified the correct materials being used and that the install appears to match the approved plans and standard specs. Photos are uploaded to the system.
Misc
Informational
09/16/2019
The Redford crew was on site today working on the water line hydrant assembly’s. The crew plans to pour more thrust blocks and restraints tomorrow.
Misc
Informational
09/16/2019
The Redford crew is working on the tie in of the water line on the east side of SW Kline Ave. I will return for further inspection often lunch when the crew is ready for inspection.
Misc
Informational
09/16/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/16/2019
The Redford crew installed the continued the install for Public water lines 3-02A & 3-02B. The crew installed the line from hydrant assembly at station 1+46.50 to 1+00 to complete line 3-02B. The crew installed the line 3-02A from station 1+26.87 to approximately 2+00. The crew plans to pour thrust blocks and thrust restraints at 4PM today and will leave them open for inspection tomorrow morning. I verified that the valves and iron fittings are poly wrapped and that the install meets the City of Lee’s Summit Standard Specs.
Misc
Informational
09/16/2019
The Redford crew is continuing the install for the public water line 3-02A The crew installed 8” C900 line from approximately 1+96.27 to 3+00 and installed hydrant assembly at station 2+69.27 Photos are attached. I will return for further inspection this afternoon.
Misc
Informational
09/16/2019
Redford installed the 8” water main line 3-02A from station 2+00 to approximately 4+00 Thrust blocks and restraints were installed for lines 3-02A & 3-02B The crew also started the 8” water main line 3-03A install from station 1+00 to approximately 3+00. Photos are attached.
Misc
Informational
09/16/2019
The Redford crew was continuing the water line install. The crew is currently backfilling the trenches. I will return this afternoon for further inspection.
Misc
Informational
09/16/2019
The Redford crew installed the section of water line along SW Kline Ave where the existing blow off assembly was to be removed, station 5+89.09 The water line along this section was moved slightly with in the right of way to avoid intersecting with a large tree and other utilities in the way. The deviation will be drawn to reflect changes in the As Built drawings.
Misc
Informational
09/16/2019
The City of Lee’s Summit Water Utilities Dept. was on site installing the construction taps in preparation for the water line chlorination.
Misc
Informational
09/16/2019
Daniel with Redford Construction chlorinated the water main. The line will sit over the weekend and the crew plans to flush on Monday prior to taking a water sample.
Misc
Informational
09/16/2019
Daniel with Redford construction flushed the water line of the chlorine. I verified the chlorine strips read the correct residue amount. They plan to take a day 1 sample tomorrow to the lab.
Misc
Informational
09/20/2019
The Redford crew plugged the construction taps and is flushing the air from the line to put it into service. The crew also backfilling the open trenches as they move along.
Grading/Excavation/Fill Inspection Partial 10/21/2019
Misc
Informational
10/21/2019
Steven Conrick and I were on site this morning and reviewed the MDP. We sent the MDP back to Sue Pyles with our comments on it.
Erosion Control Inspection Failed 02/06/2020
Misc
Corrective Action Required
02/06/2020
There is an area along SW KLINE AVE where the silt fence was knocked down and is allowing silt and mud to wash onto the property behind it at 3200 SW RAGAN CT. Please clean the silt and mud from the property at 3200 SW RAGAN CT and make corrections to the erosion control devices as soon as possible to control the silt and mud from washing off site and onto the surrounding properties. Photos of area are uploaded.
Erosion Control Inspection Failed 03/17/2020
Misc
Resolved
03/17/2020
The silt fence along the west side of the property and the diversion berm along the south side appear to be installed according to the plans. The temporary sediment trap # 2 appears to be installed according to the plans. There are areas along the east side of the property that need to be corrected. There are low areas that still need self fence installed and the diversion berm needs to be corrected to properly direct flow into the trap.
Misc
Resolved
03/17/2020
PW-Devices for Erosion and Sediment Control
Resolved
03/17/2020
There are problems with the erosion control devices on your site.
PW-Erosion and Sediment Control
Resolved
03/17/2020
Your project is in violation of the Erosion and Sediment control policy. Silt fence or other acceptable erosion control devices need to be installed on site. There is a significant amount of silt and debris washing out along SW Kline Rd where the new street is going to be tied in and also along SW Morris Dr just north of the construction site. Please make corrections to the erosion control devices asap. Photos are attached to the permit.
Misc
Resolved
03/17/2020
UPDATE Thomas Hudgens with Redford Construction met me on site to discuss a solution and he plans to have a crew out asap to clean the washed out areas and get erosion control devices installed. I will update when the work is completed.
PW-Devices for Erosion and Sediment Control
Resolved
03/17/2020
There are problems with the erosion control devices on your site. ESC devices need to be installed along the roadway especially in the lower lying areas. The gutter buddies are starting to fill in with silt due to the heavy rain event and need cleaned out and maintained. Please make corrections promptly to the ESC devices to avoid any work stoppage.
Misc
Corrective Action Required
03/17/2020
EROSION CONTROL INSPECTION FAILED There are areas on site where the erosion control devices have failed and need to be corrected. Clean silt and mud from the inlet protection devices and install them according to the City of Lee’s Summit standards. The inlet protection devices need to be blocked behind them to prevent clogging of the inlets and they need to extend far enough on both sides of the inlet to be effective. Silt fence or other acceptable measures need to be installed along SW KLINE AVE at the entrance of the silt to stop silt and mud from running down the sidewalk and on the existing residential properties. Photos of the wash out are uploaded to the system.
Erosion Control Inspection Failed 7/23/2020 07/23/2020
PW-Erosion and Sediment Control
Corrective Action Required
07/23/2020
Your project is in violation of the Erosion and Sediment control policy. We received an email with pictures of erosion control problems on this site from the Missouri Department of Natural Resources. There appears to be a can of trash that was dumped in the road at a dead end. All the gutter buddys in the curb inlets need to be cleaned out of the mud and silt. Some of them are growing weeds in them. Please take care of these items as soon as possible.We will check back on Tuesday July 28. Please notify the builders to make sure their erosion control devices are in place.
Erosion Control Inspection Failed 07/29/2020
Misc
Resolved
07/29/2020
There is an area along SW KLINE AVE where the silt fence was knocked down and is allowing silt and mud to wash onto the property behind it at 3200 SW RAGAN CT. Please clean the silt and mud from the property at 3200 SW RAGAN CT and make corrections to the erosion control devices as soon as possible to control the silt and mud from washing off site and onto the surrounding properties. Photos of area are uploaded.
Misc
Corrective Action Required
07/29/2020
Your project is in violation of the Erosion and Sediment control policy. We received an email with pictures of erosion control problems on this site from the Missouri Department of Natural Resources. There appears to be a can of trash that was dumped in the road at a dead end. All the gutter buddys in the curb inlets need to be cleaned out of the mud and silt. Some of them are growing weeds in them. Please take care of these items as soon as possible. Please notify the builders to make sure their erosion control devices are in place.
Erosion Control Inspection Failed 07/30/2020
PW-Erosion and Sediment Control
Corrective Action Required
07/29/2020
Your project is in violation of the Erosion and Sediment control policy. We received an email with pictures of erosion control problems on this site from the Missouri Department of Natural Resources. There appears to be a can of trash that was dumped in the road at a dead end. All the gutter buddys in the curb inlets need to be cleaned out of the mud and silt. Some of them are growing weeds in them. Please notify the builders to make sure their erosion control devices are in place. No future building permits will be issued If the erosion control devices are not corrected by the end of the day on 8/4/2020.
Erosion Control Inspection Passed 08/10/2020
PW-Erosion and Sediment Control
Corrective Action Required
07/30/2020
Your project is in violation of the Erosion and Sediment control policy. We received an email with pictures of erosion control problems on this site from the Missouri Department of Natural Resources. There appears to be a can of trash that was dumped in the road at a dead end. All the gutter buddys in the curb inlets need to be cleaned out of the mud and silt. Some of them are growing weeds in them. Please notify the builders to make sure their erosion control devices are in place. No future building permits will be issued If the erosion control devices are not corrected by the end of the day on 8/4/2020.
Misc
Informational
08/10/2020
The inlet protection devices have been cleaned and or replaced. The trash at the dead end of SW Monarch DR has been cleaned up.
Documents & Images
Date Uploaded File Type Document Name
12/06/2018 Receipt Receipt for transaction: 2018-007478
03/20/2019 image13
03/20/2019 image14
03/20/2019 image15
03/20/2019 image16
03/20/2019 Letter INSPECTION SUMMARY
03/21/2019 image19
03/21/2019 image20
03/21/2019 Letter INSPECTION SUMMARY
03/21/2019 image18
03/21/2019 image17
03/19/2019 Letter INSPECTION SUMMARY
03/19/2019 image12
03/19/2019 image11
03/19/2019 Letter INSPECTION SUMMARY
03/19/2019 image10
03/19/2019 image9
03/18/2019 Letter INSPECTION SUMMARY
03/18/2019 image8
03/18/2019 image7
03/18/2019 Letter INSPECTION SUMMARY
03/18/2019 Letter INSPECTION SUMMARY
03/18/2019 image6
03/18/2019 image5
03/18/2019 image4
03/18/2019 image3
03/18/2019 image2
03/18/2019 image1
03/18/2019 image0
03/18/2019 image
03/05/2019 Letter INSPECTION SUMMARY
01/02/2019 SVF-3rdPLAT Signed Permit
01/02/2019 Letter DE-Permit
03/26/2019 image21
03/26/2019 image22
03/26/2019 image23
03/26/2019 Letter INSPECTION SUMMARY
03/27/2019 image24
03/27/2019 image25
03/27/2019 image26
03/27/2019 image27
04/01/2019 Letter INSPECTION SUMMARY
04/01/2019 Letter INSPECTION SUMMARY
04/02/2019 Letter INSPECTION SUMMARY
04/03/2019 image28
04/03/2019 image29
04/03/2019 image30
04/03/2019 Letter INSPECTION SUMMARY
04/09/2019 Letter INSPECTION SUMMARY
04/09/2019 image31
04/09/2019 image32
04/09/2019 image33
04/09/2019 image34
04/09/2019 image35
04/09/2019 image36
04/09/2019 image37
04/09/2019 image38
04/09/2019 image39
04/09/2019 Letter INSPECTION SUMMARY
04/16/2019 image53
04/11/2019 image40
04/17/2019 image62
04/17/2019 image63
04/17/2019 image64
04/17/2019 image65
04/17/2019 image66
04/17/2019 Letter INSPECTION SUMMARY
04/11/2019 image41
04/11/2019 image42
04/11/2019 image43
04/11/2019 image44
04/11/2019 image45
04/11/2019 image46
04/11/2019 image47
04/11/2019 image48
04/11/2019 image49
04/11/2019 image50
04/11/2019 Letter INSPECTION SUMMARY
04/16/2019 image51
04/16/2019 image52
04/16/2019 image54
04/16/2019 image55
04/16/2019 image56
04/16/2019 image57
04/16/2019 image58
04/16/2019 image59
04/16/2019 image60
04/16/2019 image61
04/16/2019 Letter INSPECTION SUMMARY
04/16/2019 Letter INSPECTION SUMMARY
04/17/2019 Letter INSPECTION SUMMARY
06/03/2019 Letter INSPECTION SUMMARY
06/03/2019 Letter INSPECTION SUMMARY
04/22/2019 image67
04/22/2019 image68
04/22/2019 image69
04/22/2019 image70
04/22/2019 image71
04/22/2019 Letter INSPECTION SUMMARY
05/15/2019 Letter INSPECTION SUMMARY
05/15/2019 Letter INSPECTION SUMMARY
05/17/2019 Letter INSPECTION SUMMARY
06/03/2019 image72
06/03/2019 image73
06/03/2019 image74
06/03/2019 image75
06/03/2019 image76
06/03/2019 image77
06/03/2019 image78
06/03/2019 image79
06/03/2019 image80
06/03/2019 image81
06/03/2019 image82
06/03/2019 Letter INSPECTION SUMMARY
06/03/2019 image83
06/03/2019 image84
06/03/2019 image85
06/03/2019 image86
06/03/2019 image87
06/03/2019 image88
06/03/2019 image89
06/03/2019 image90
06/03/2019 image91
06/03/2019 Letter INSPECTION SUMMARY
06/04/2019 image92
06/04/2019 image93
06/04/2019 image94
06/04/2019 Letter INSPECTION SUMMARY
06/04/2019 image95
06/04/2019 790B8582-1682-48A5-9BE3-BEA2B7664F7D
06/04/2019 8F872185-7EFC-4F01-B0DB-04301C0D3E3C
06/04/2019 0817D3E4-3586-4AB5-A6D4-D2F88990FD44
06/04/2019 B8E50169-799F-45EB-A2F3-7FCEE44F61DD
06/04/2019 18442D8D-C677-4181-A628-3B0FA46E6EA7
06/04/2019 852BF649-711D-42A0-9037-EF45AD284A9A
06/04/2019 19B7F10F-8EAF-4FDC-9E2D-0258A98FCC8D
06/04/2019 ACDB403B-4E53-4523-A694-5005105FA8E7
06/04/2019 Letter INSPECTION SUMMARY
06/05/2019 Letter INSPECTION SUMMARY
06/07/2019 Letter INSPECTION SUMMARY

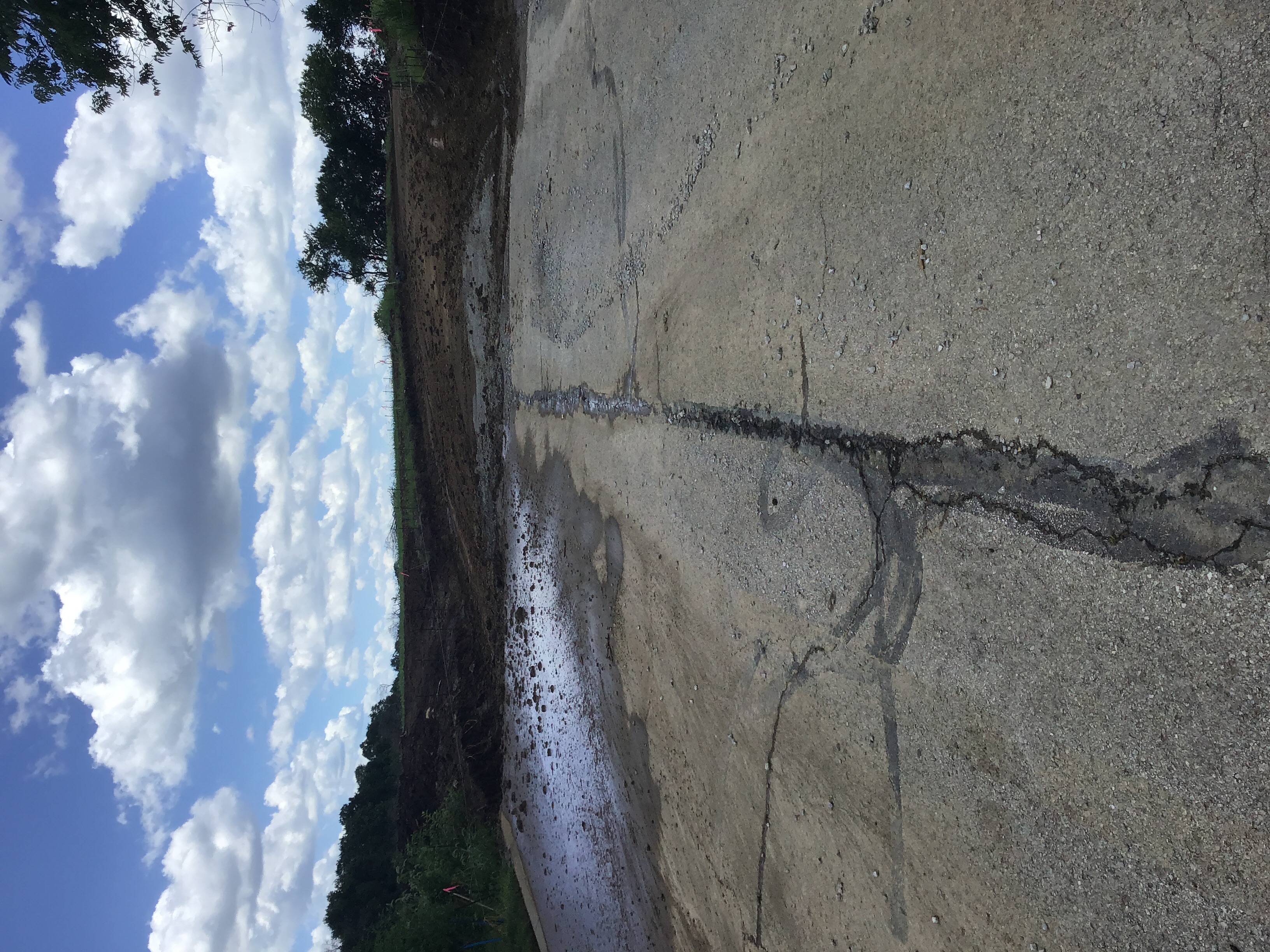

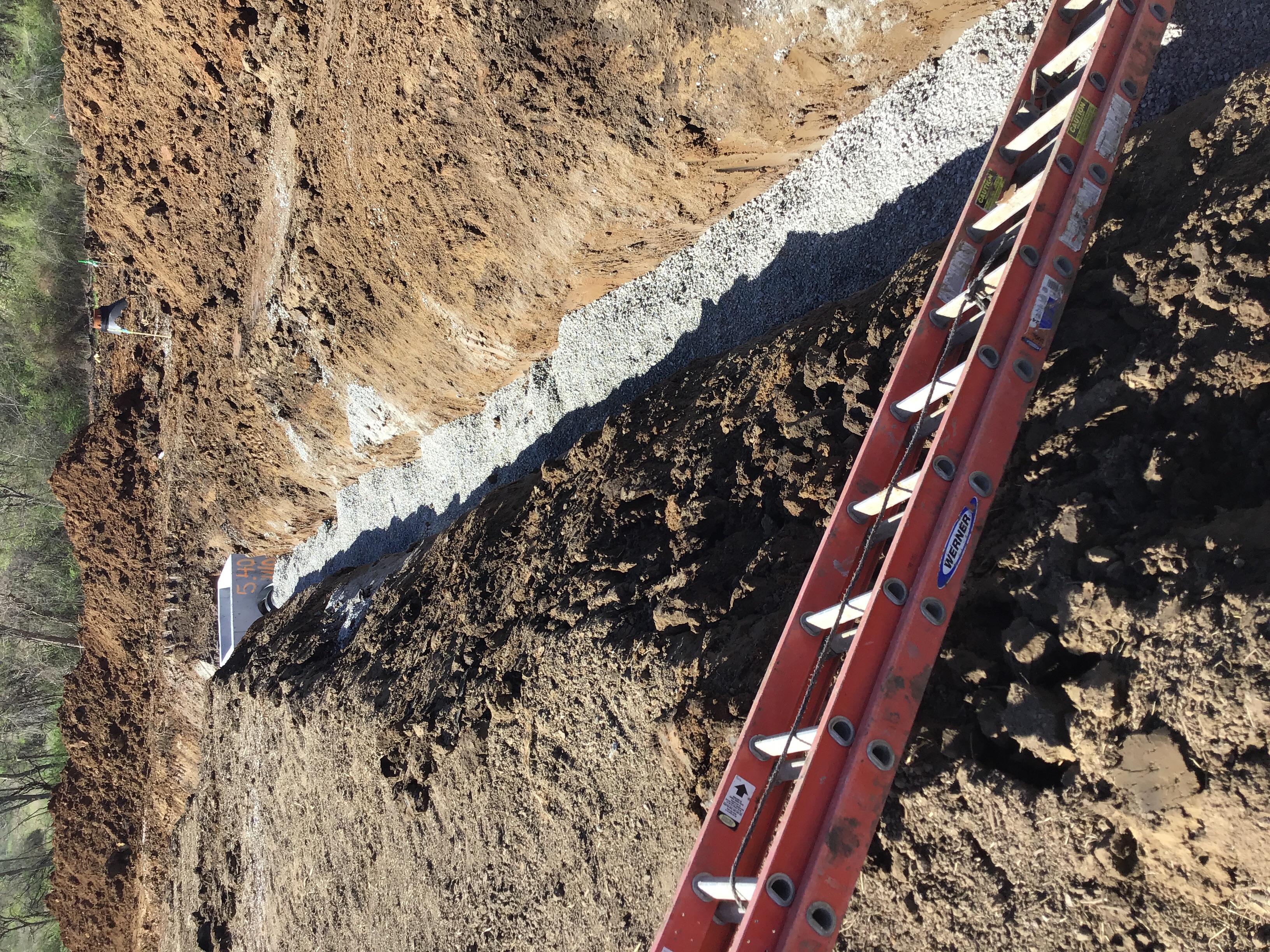

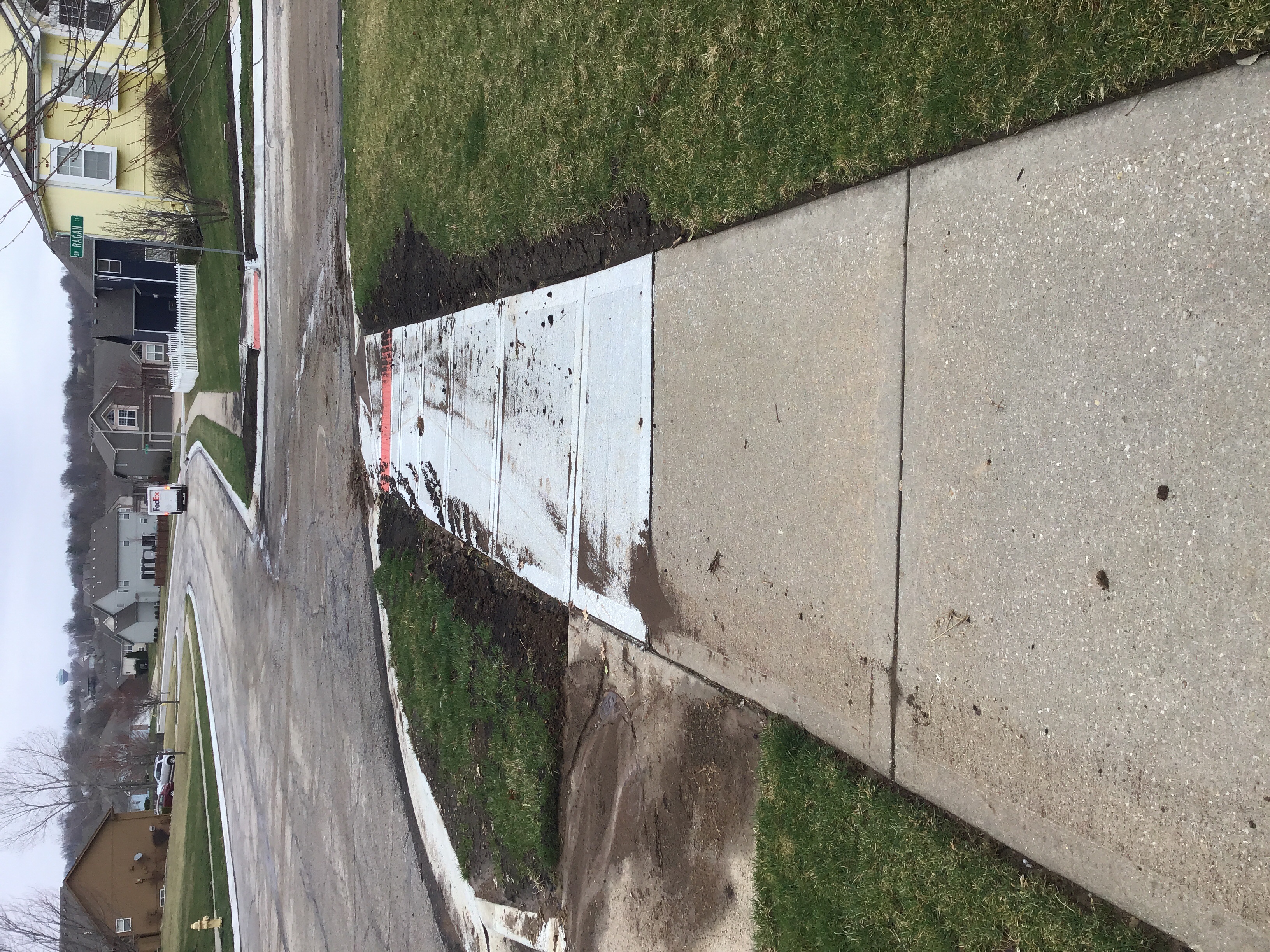

07/22/2019 Erosion Control Failure
08/21/2019 Letter INSPECTION SUMMARY
07/22/2019 Erosion control Failure SW Kline
07/22/2019 Letter INSPECTION SUMMARY
07/22/2019 Letter INSPECTION SUMMARY
06/26/2019 Receipt Receipt for transaction: 2019-004238
07/19/2019 Letter INSPECTION SUMMARY

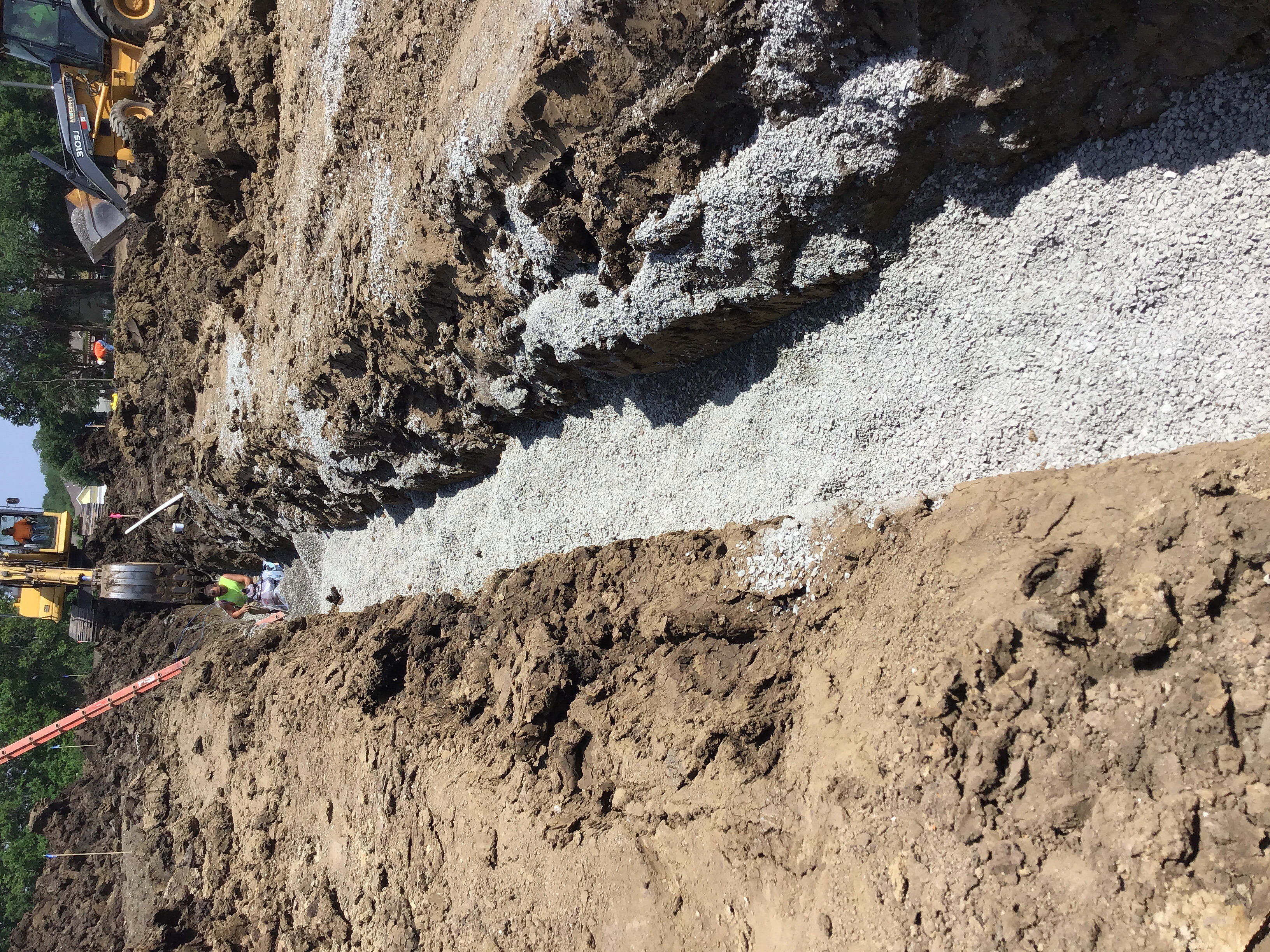

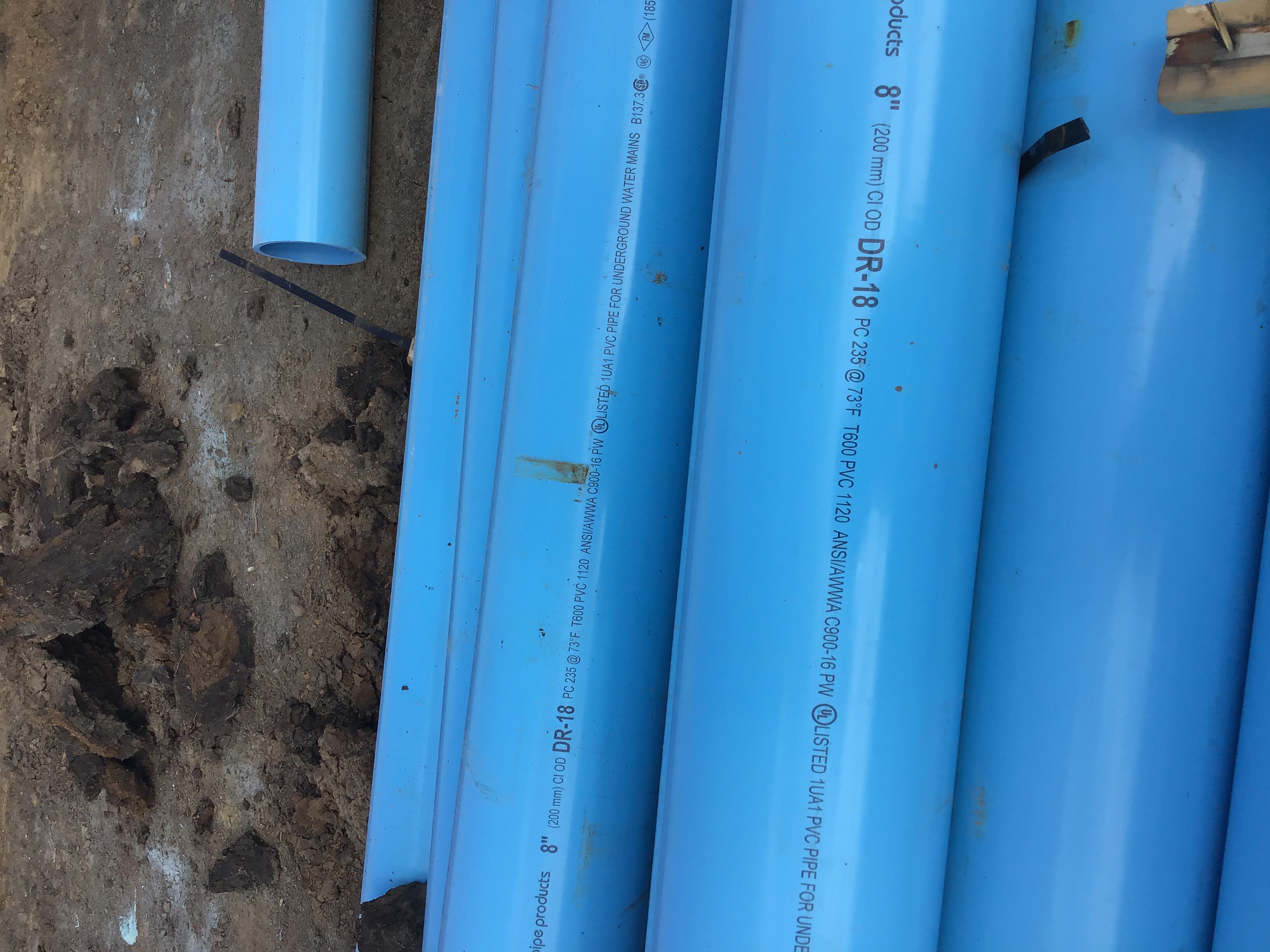

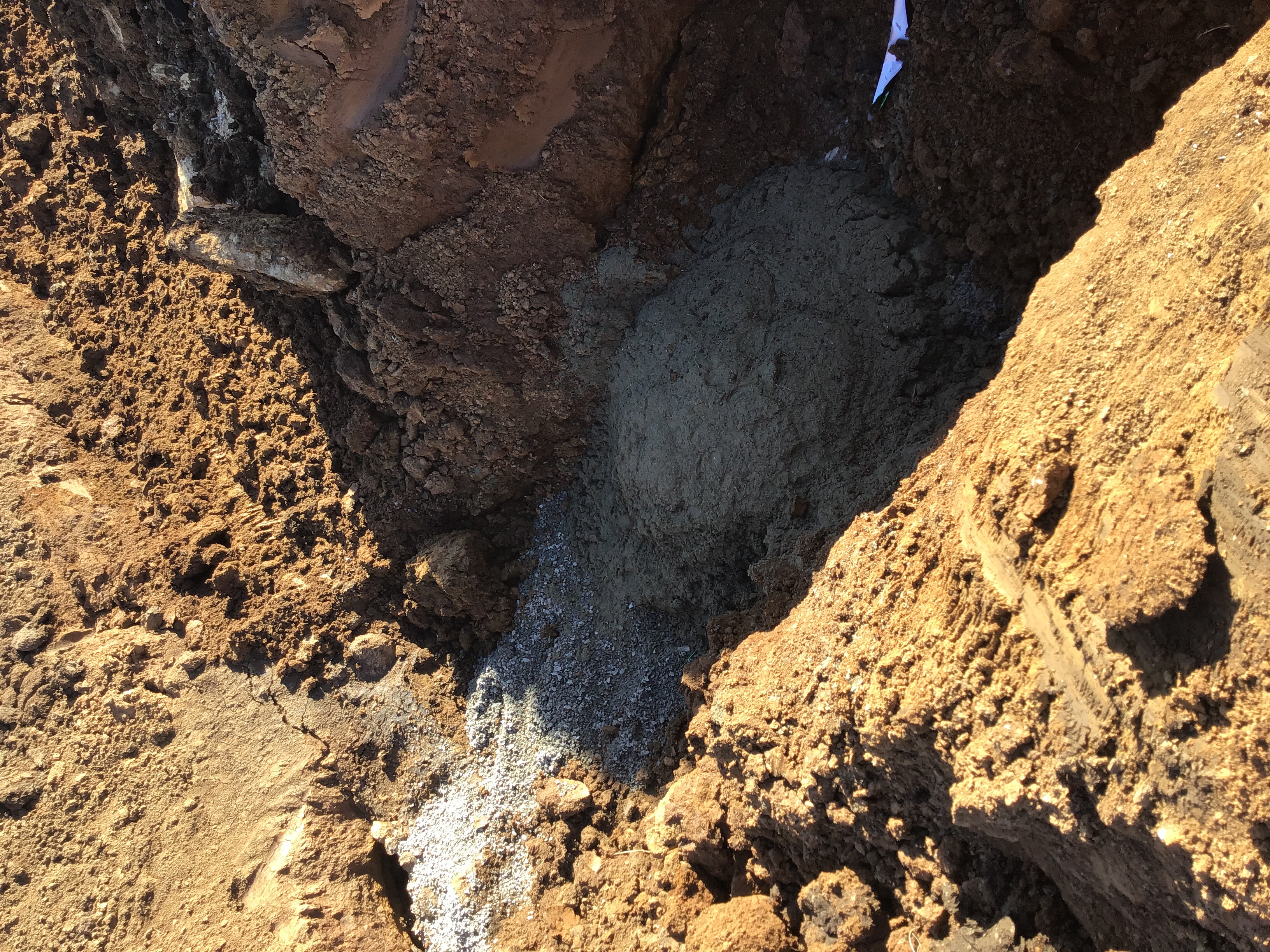

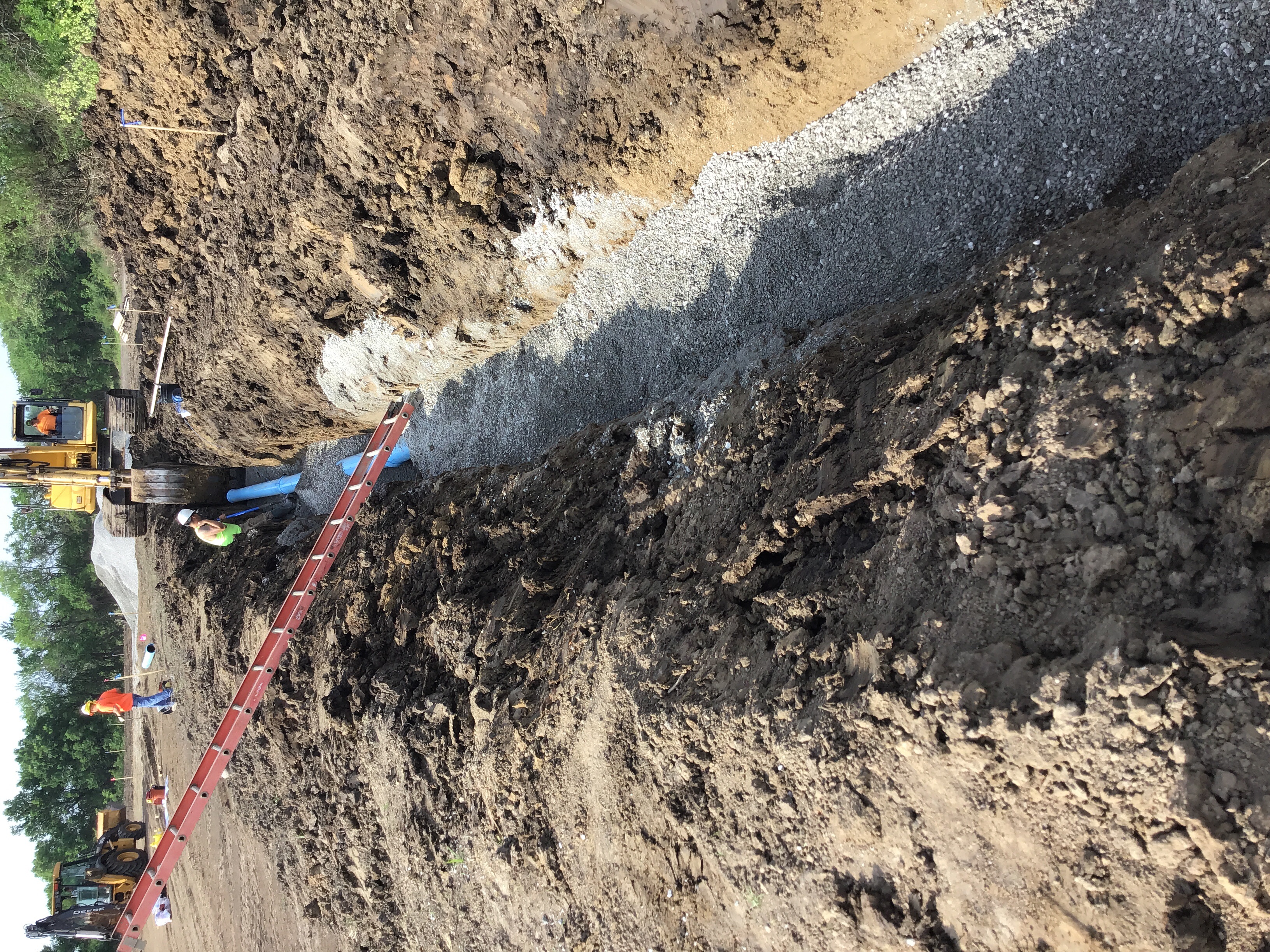

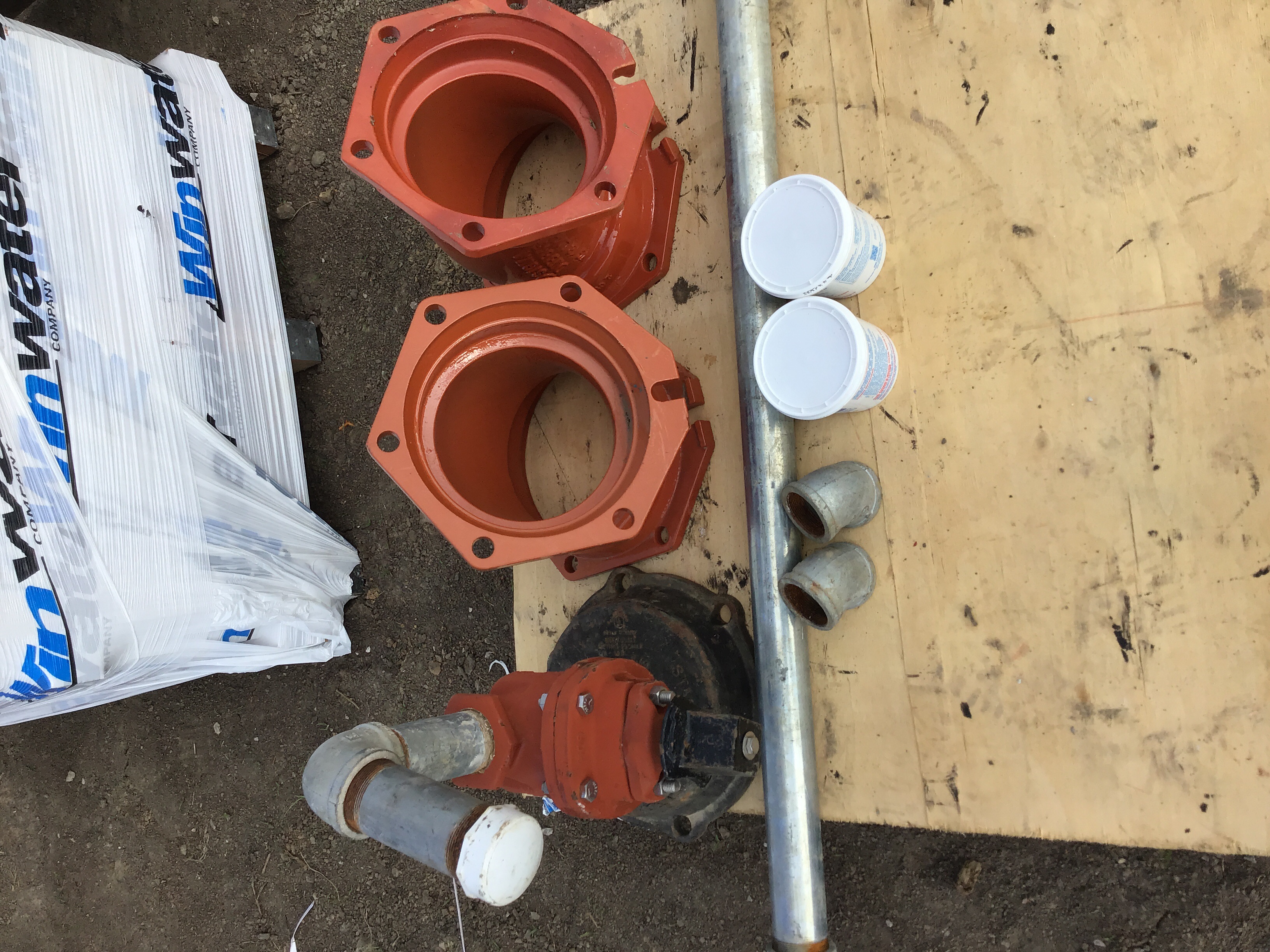

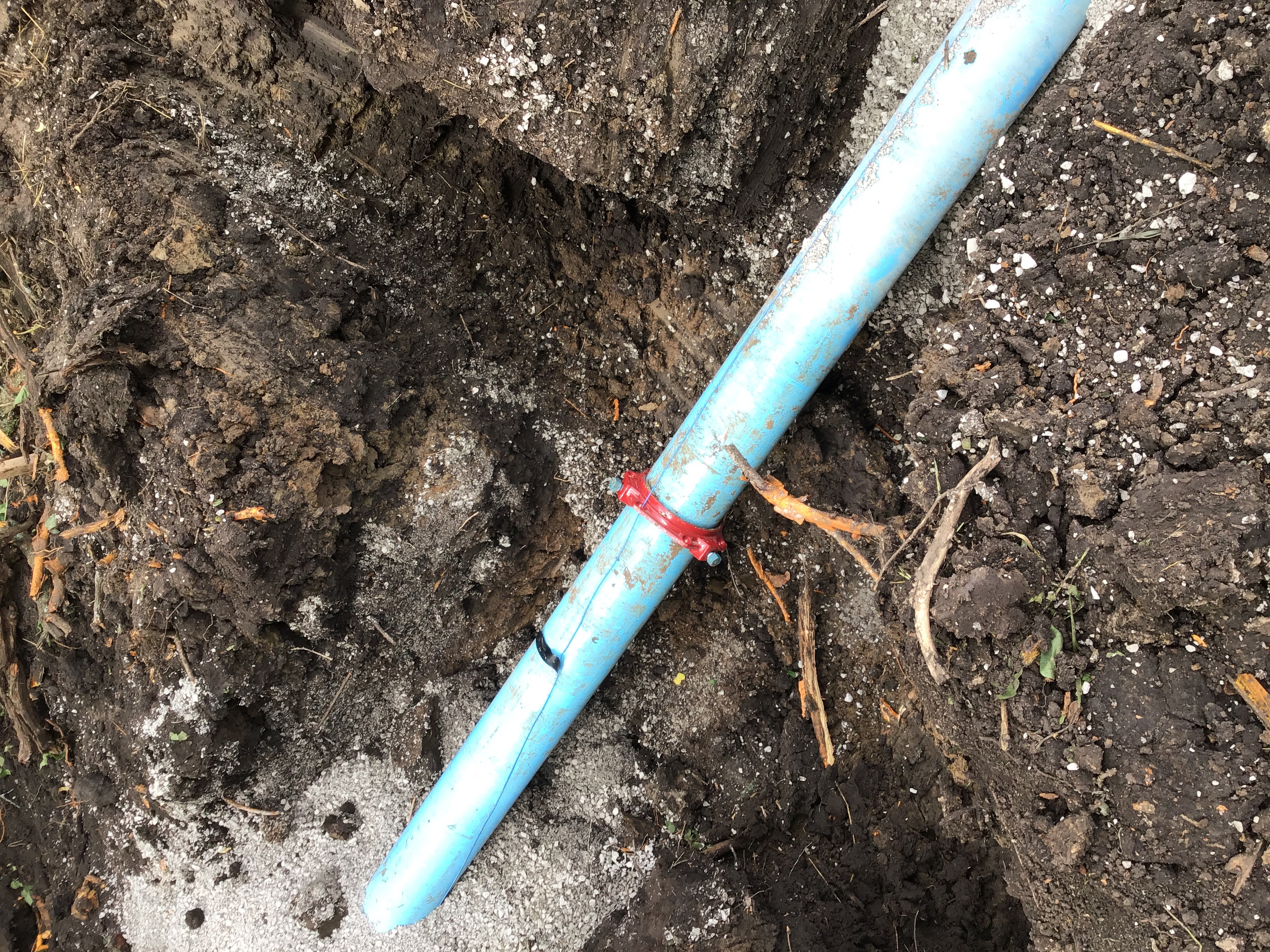

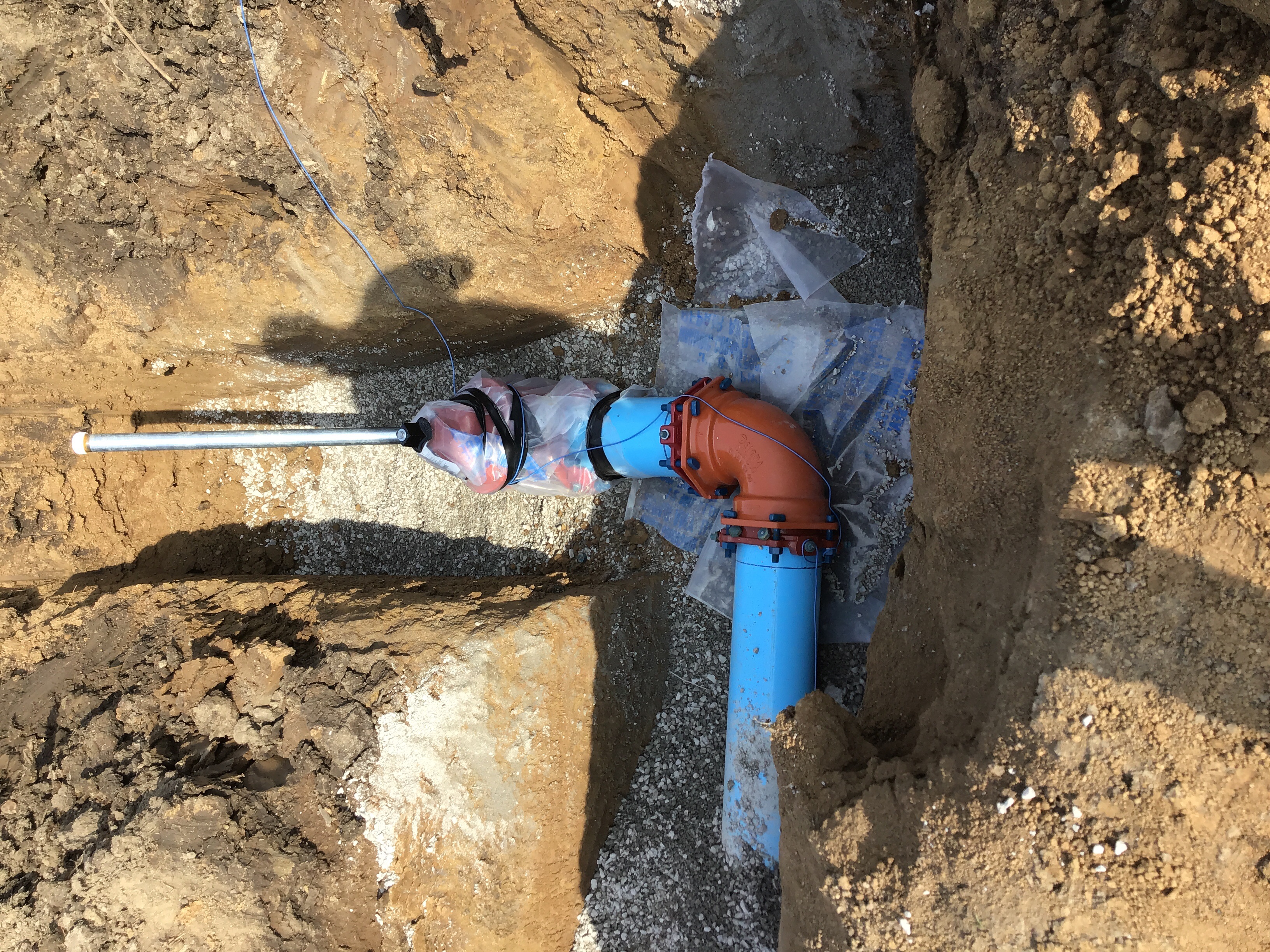

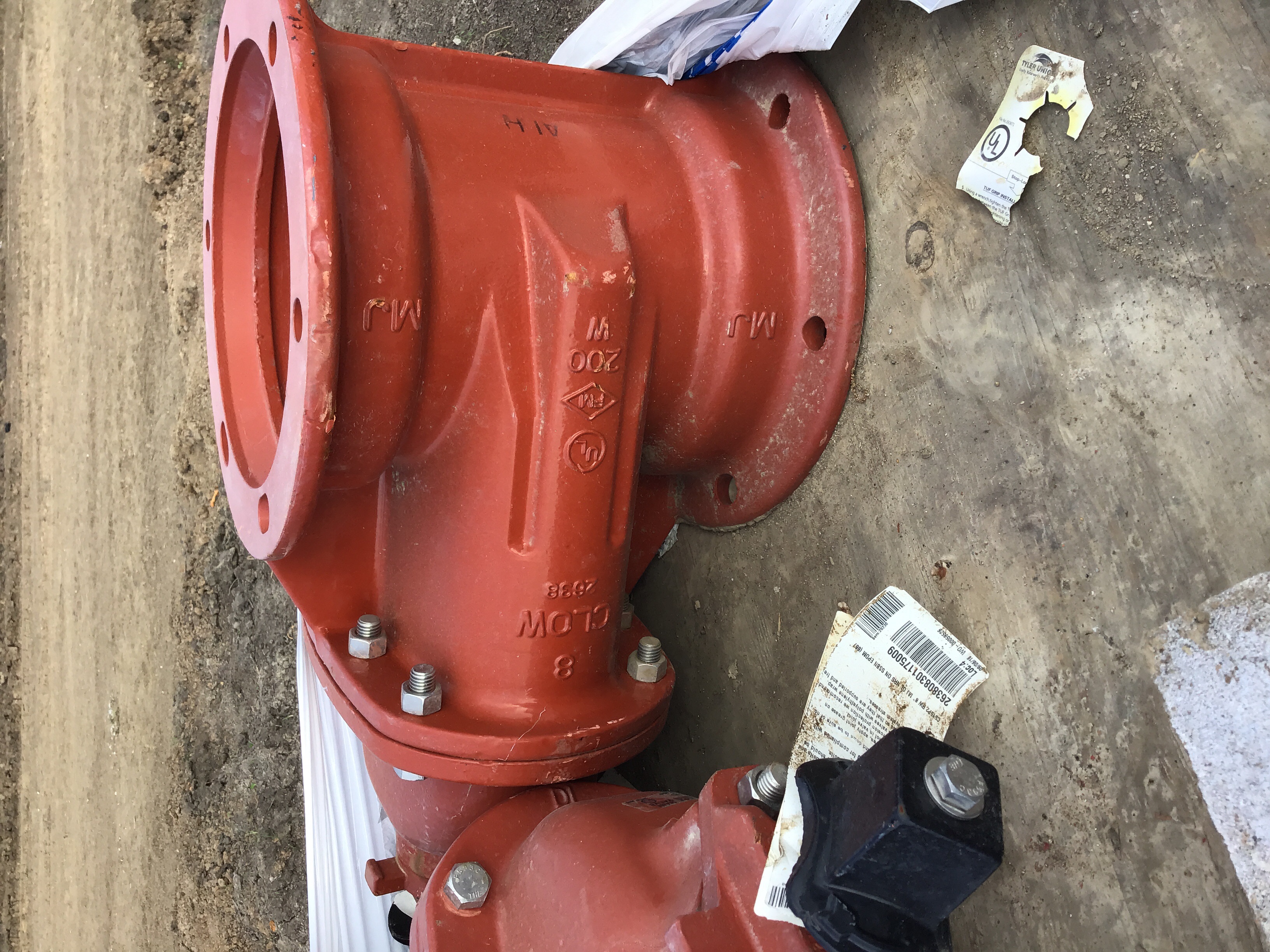

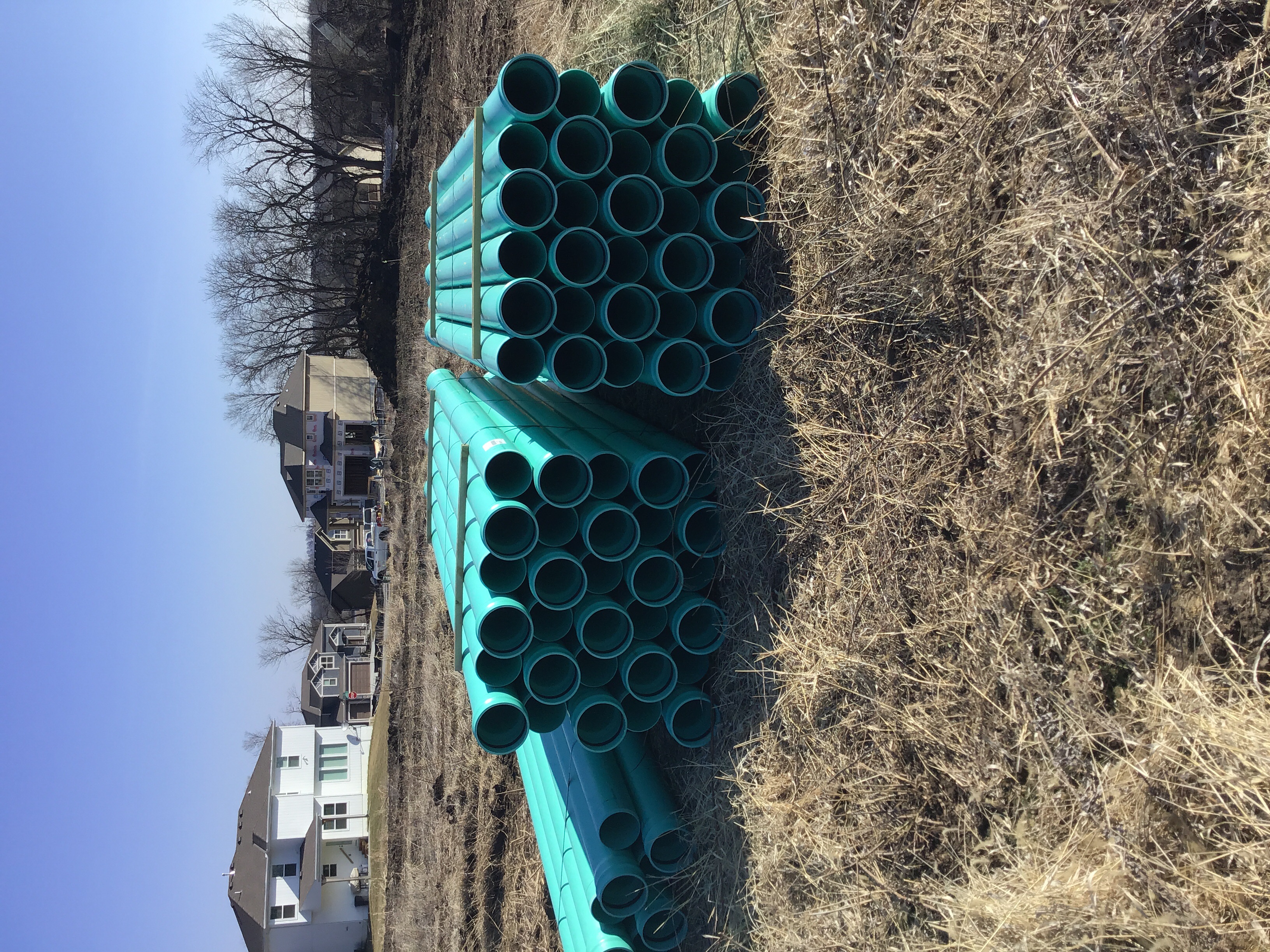

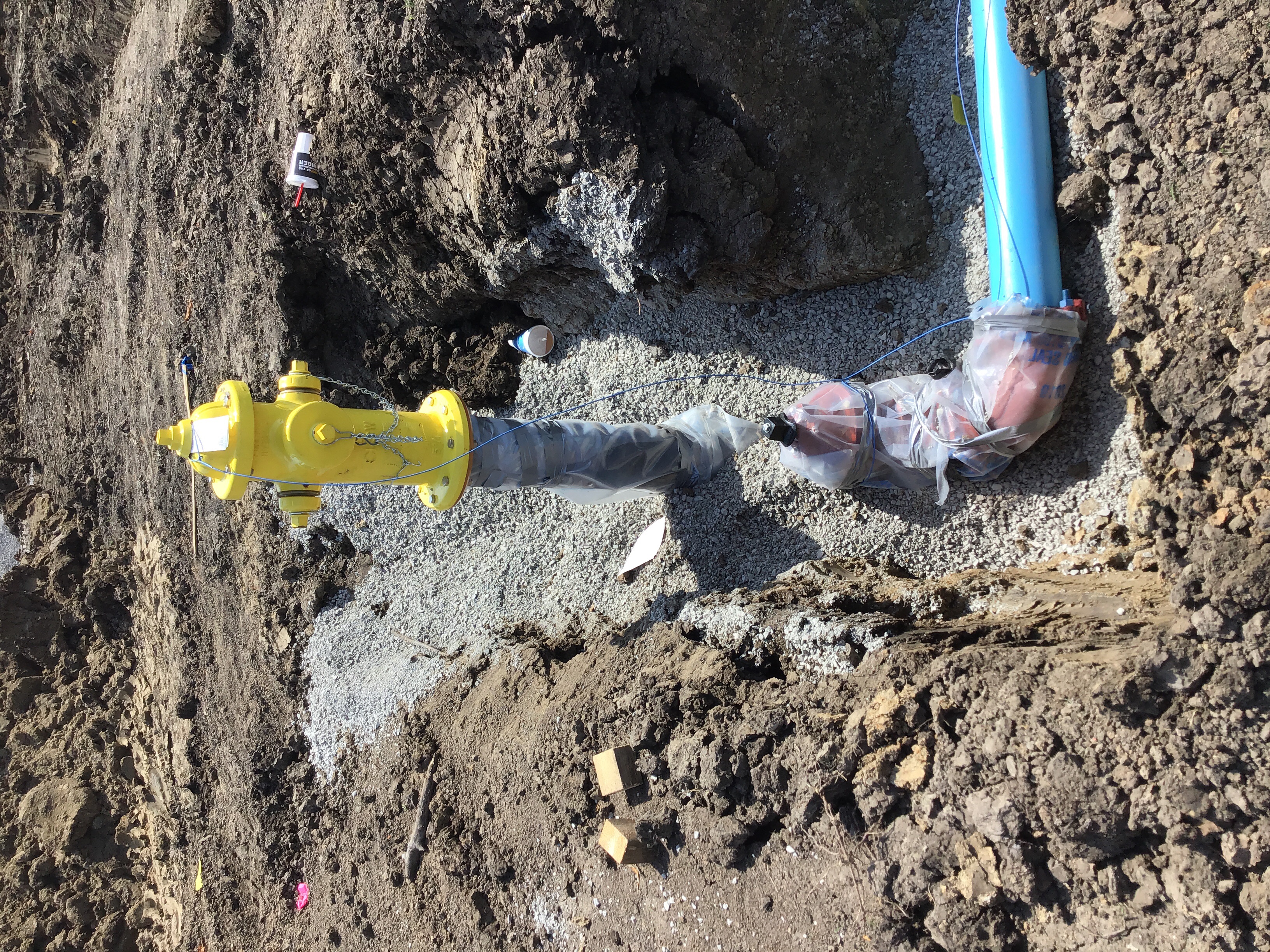

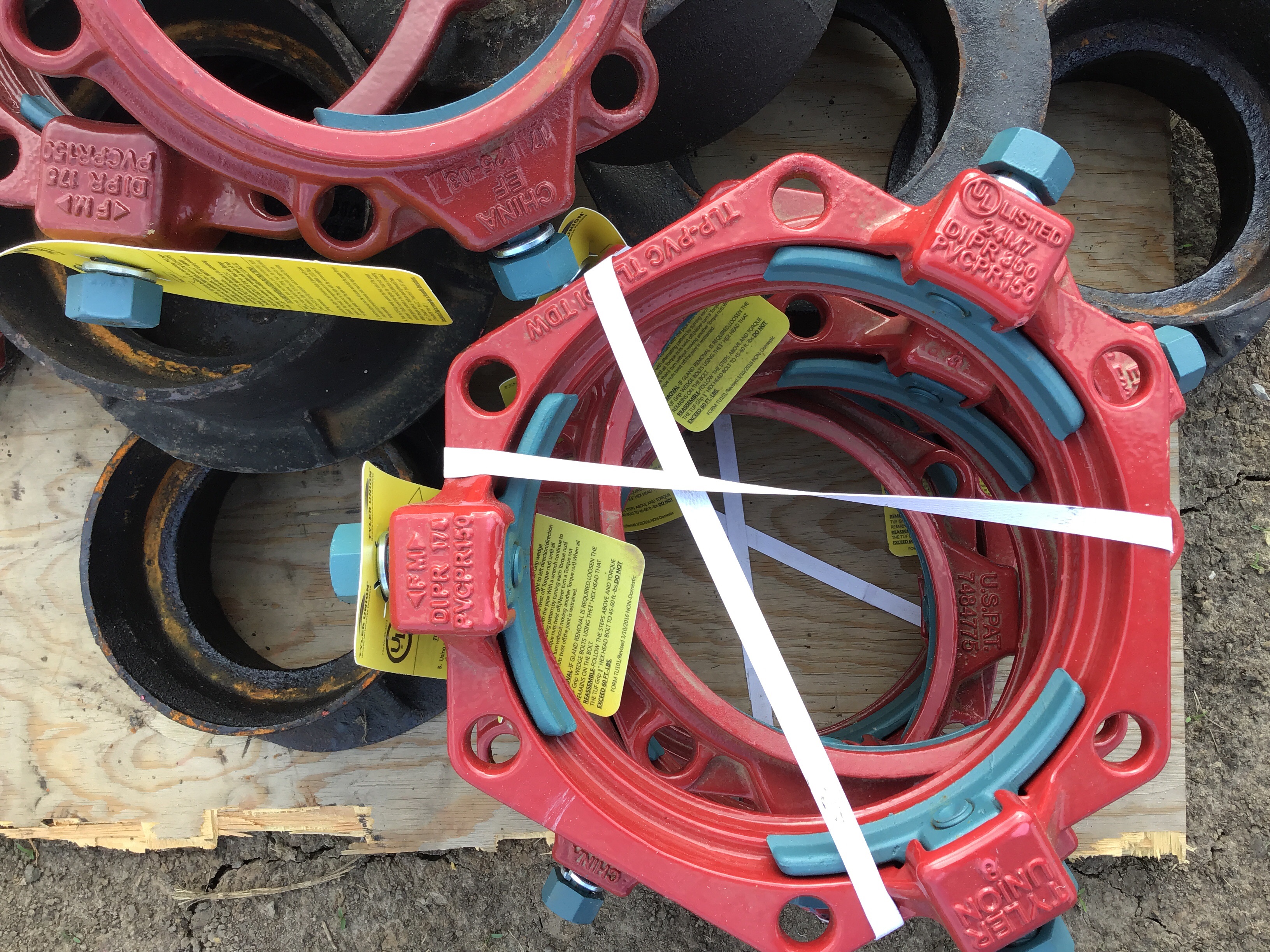

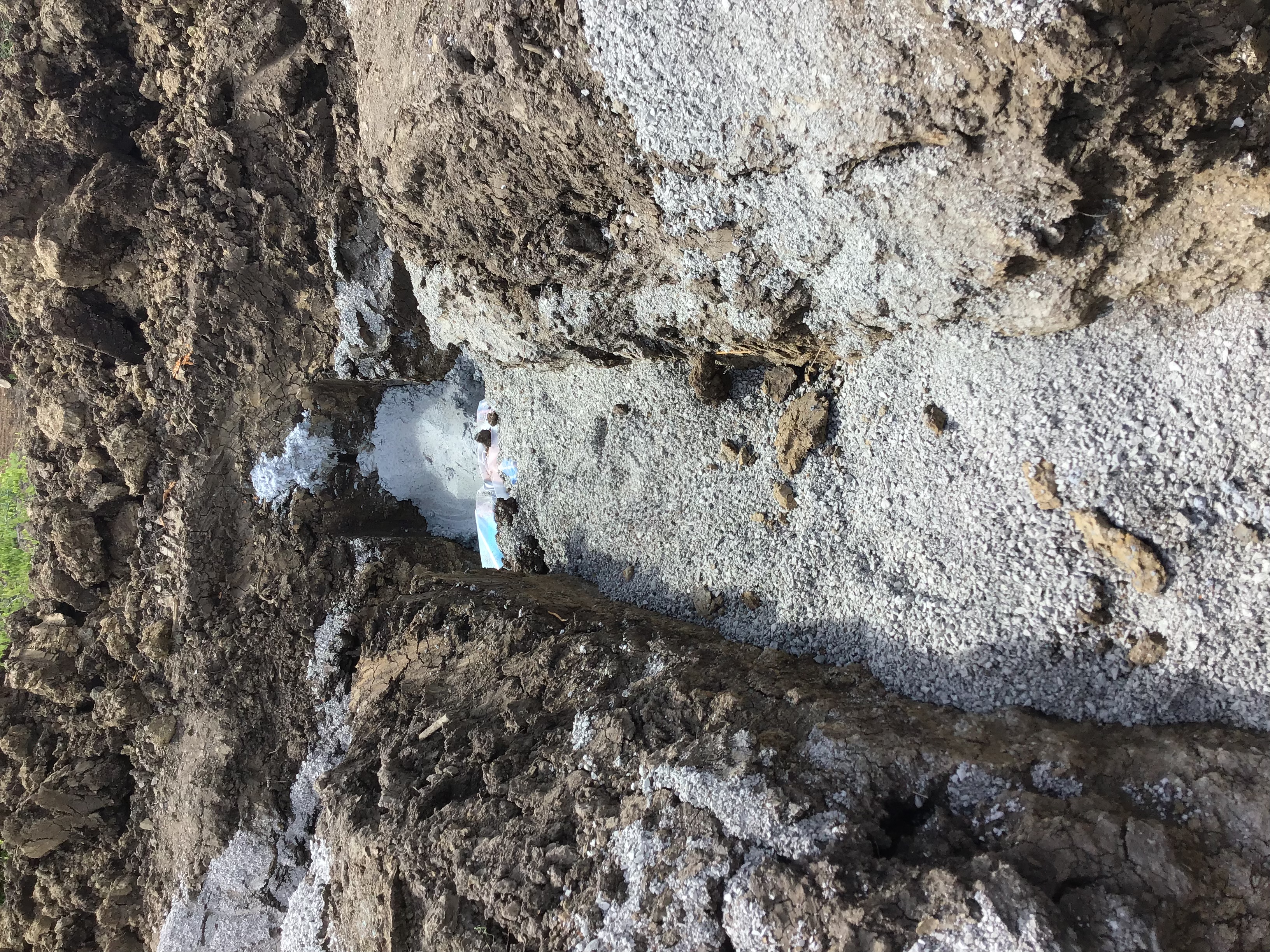

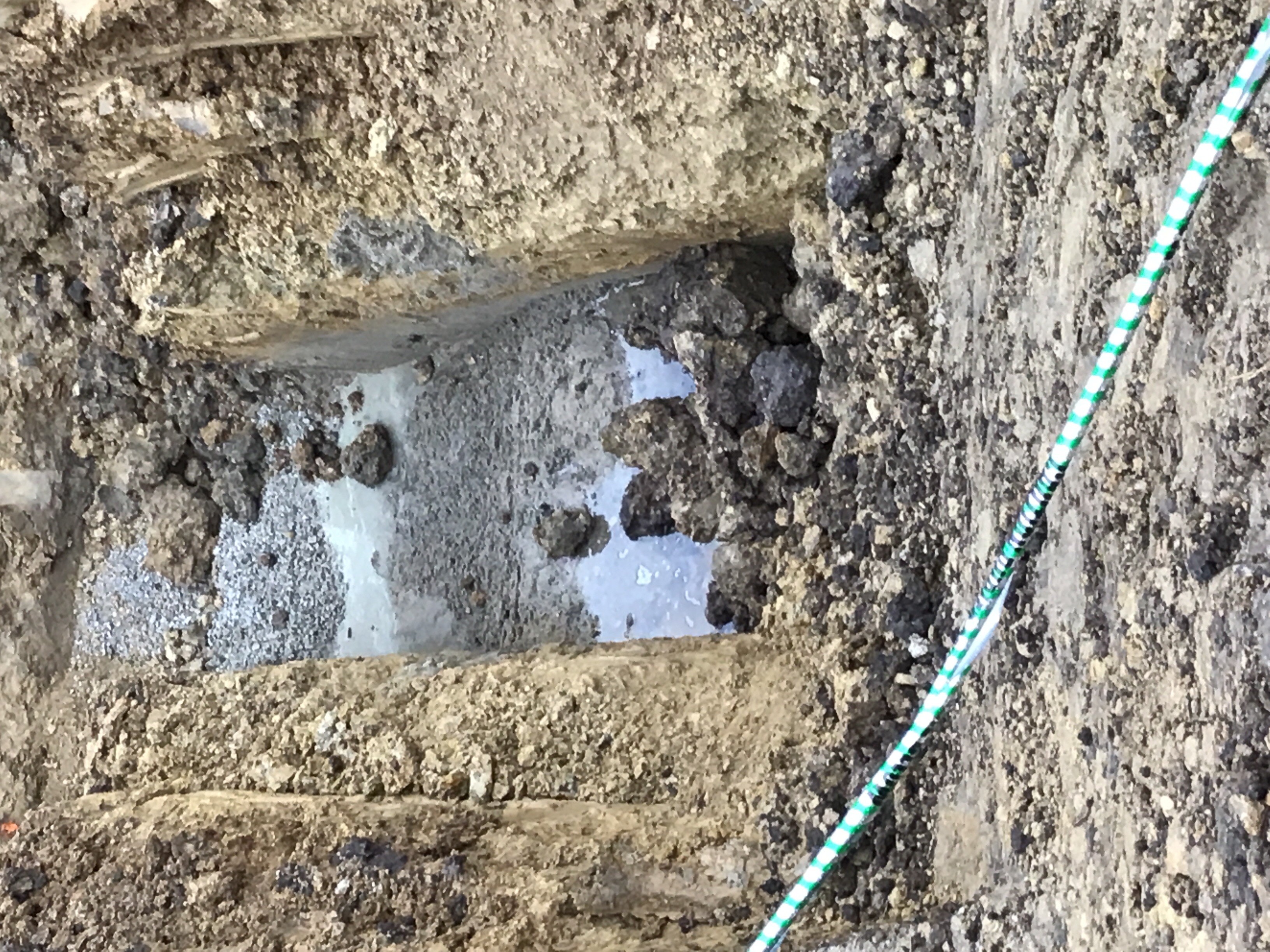

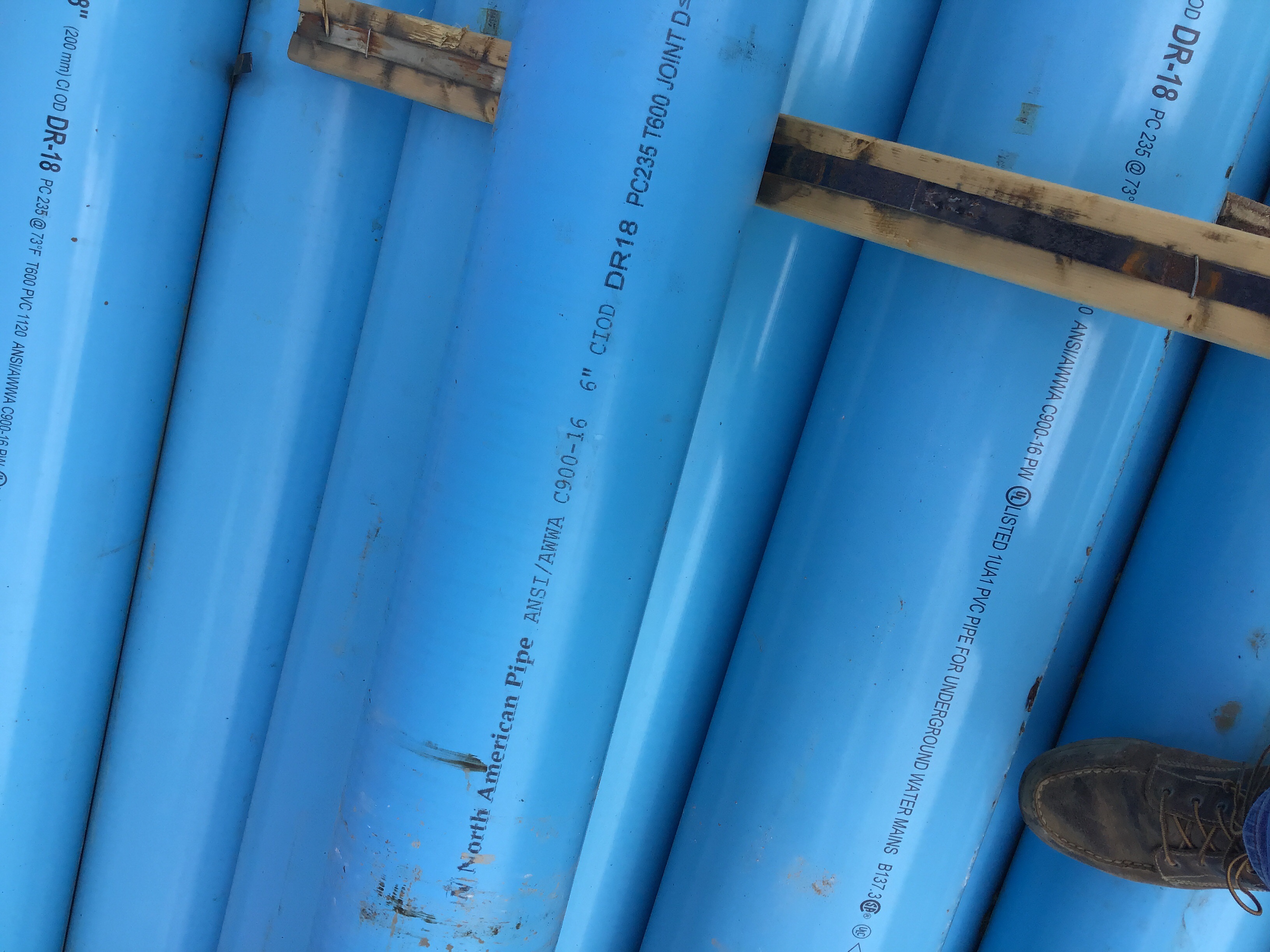

08/23/2019 Water main

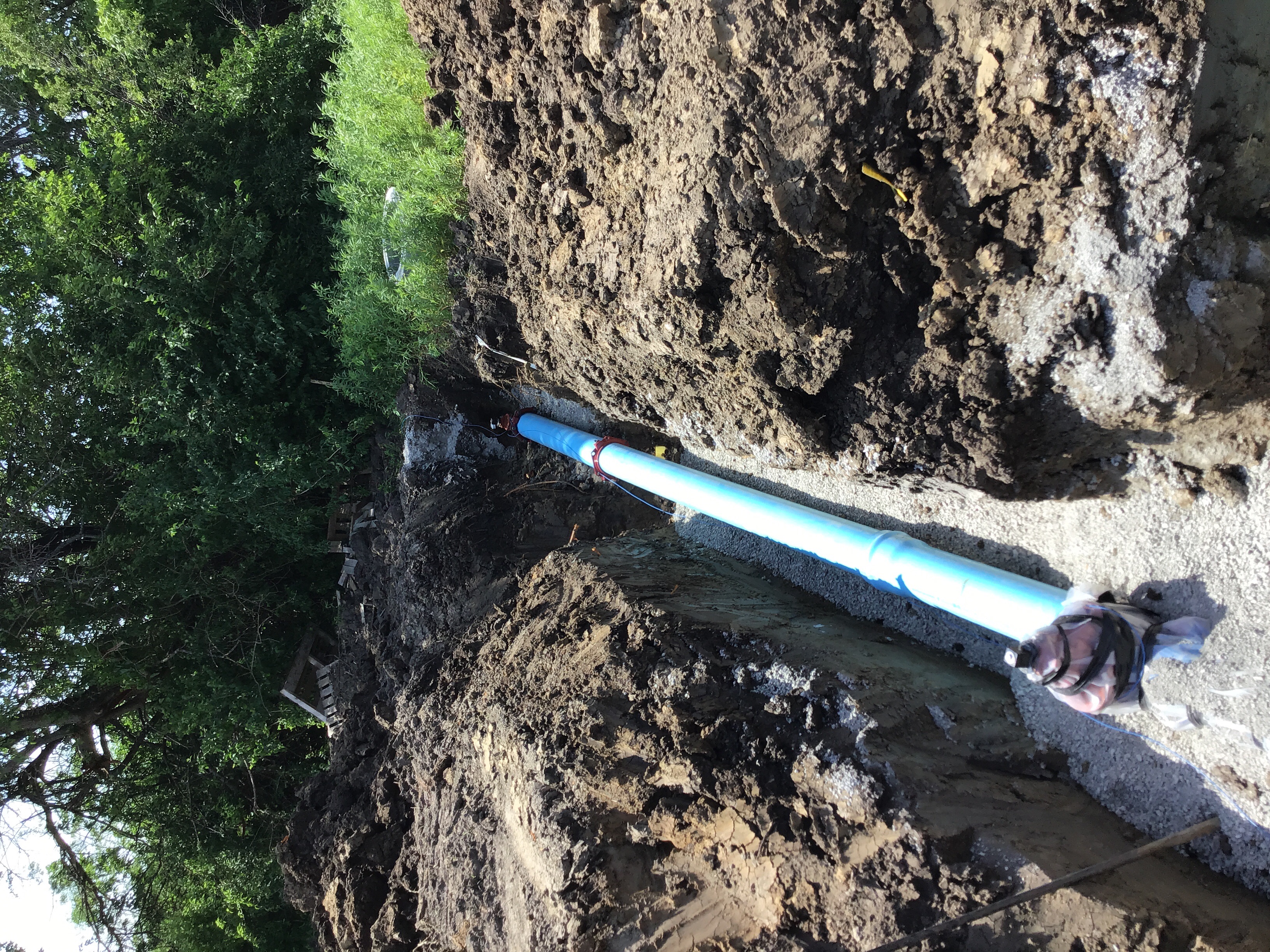

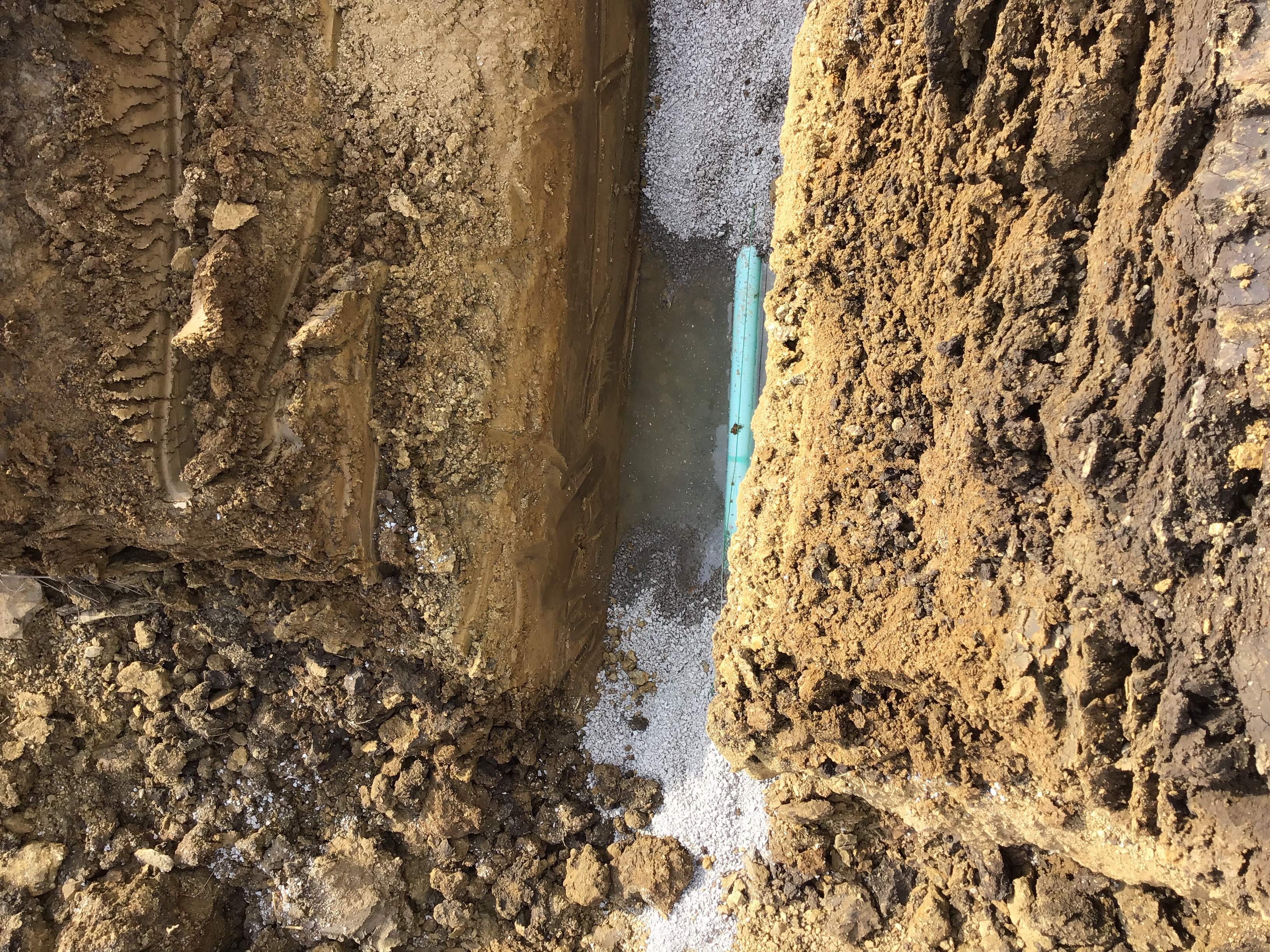

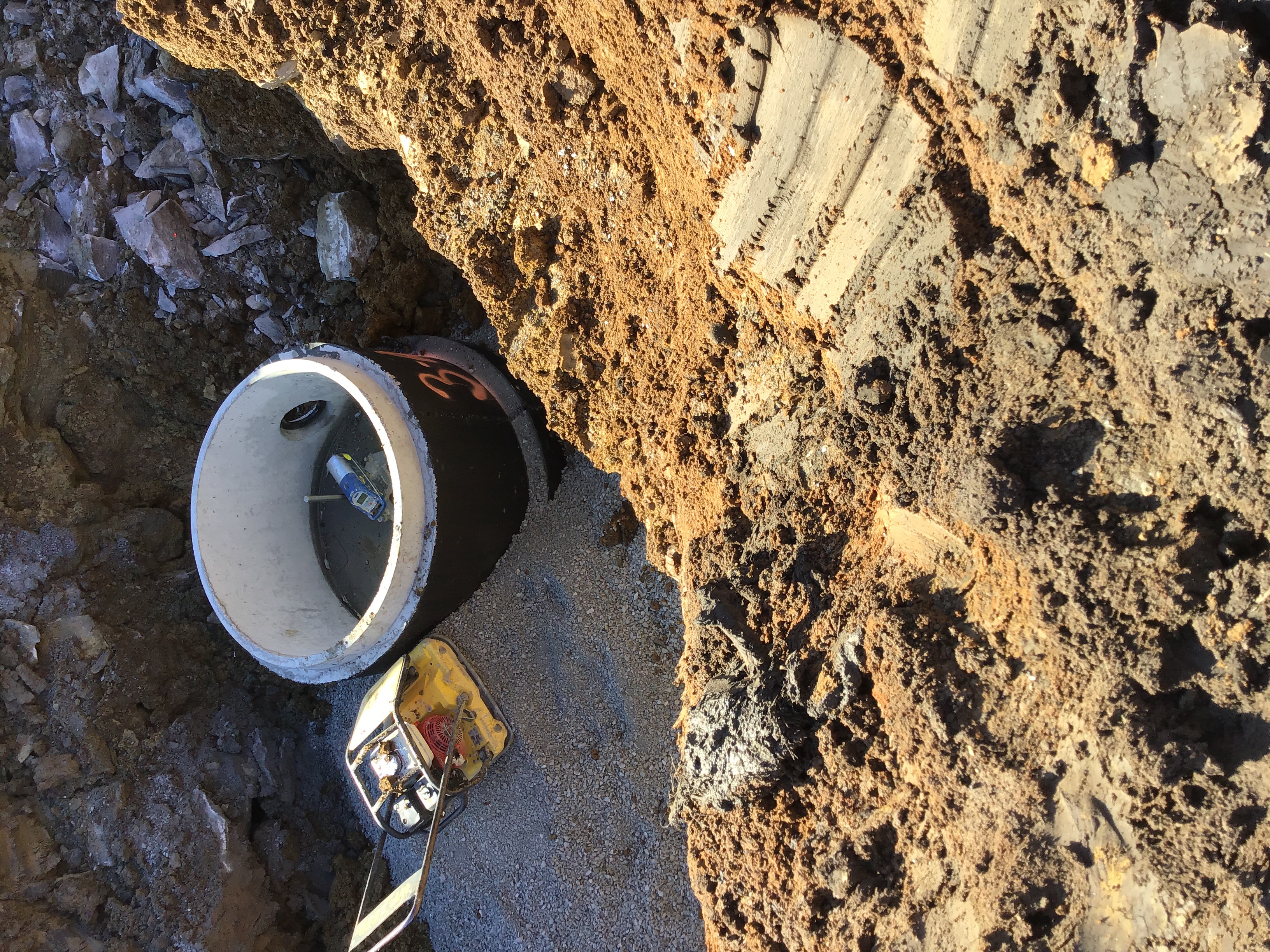

08/23/2019 Water line 3-02

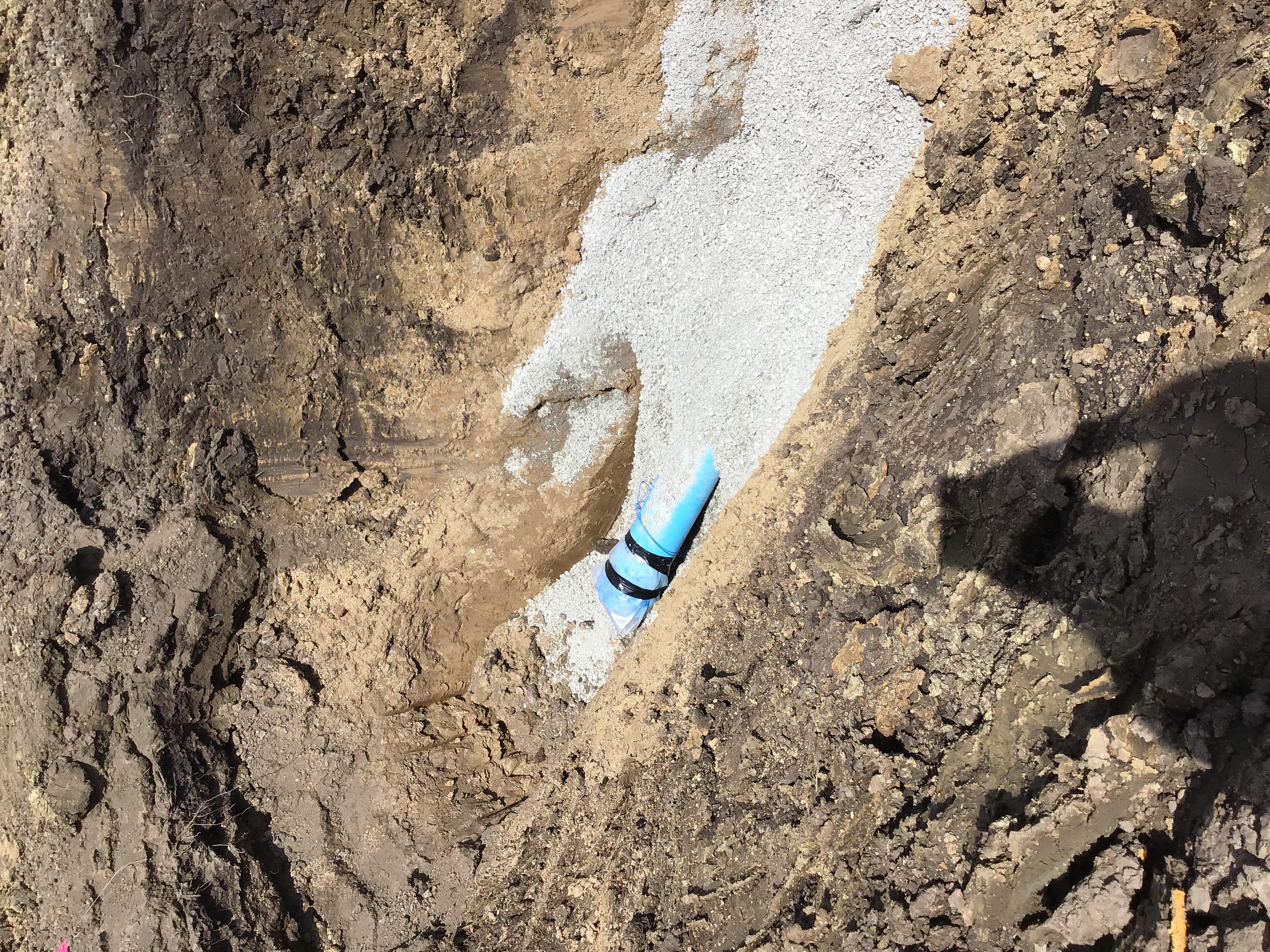

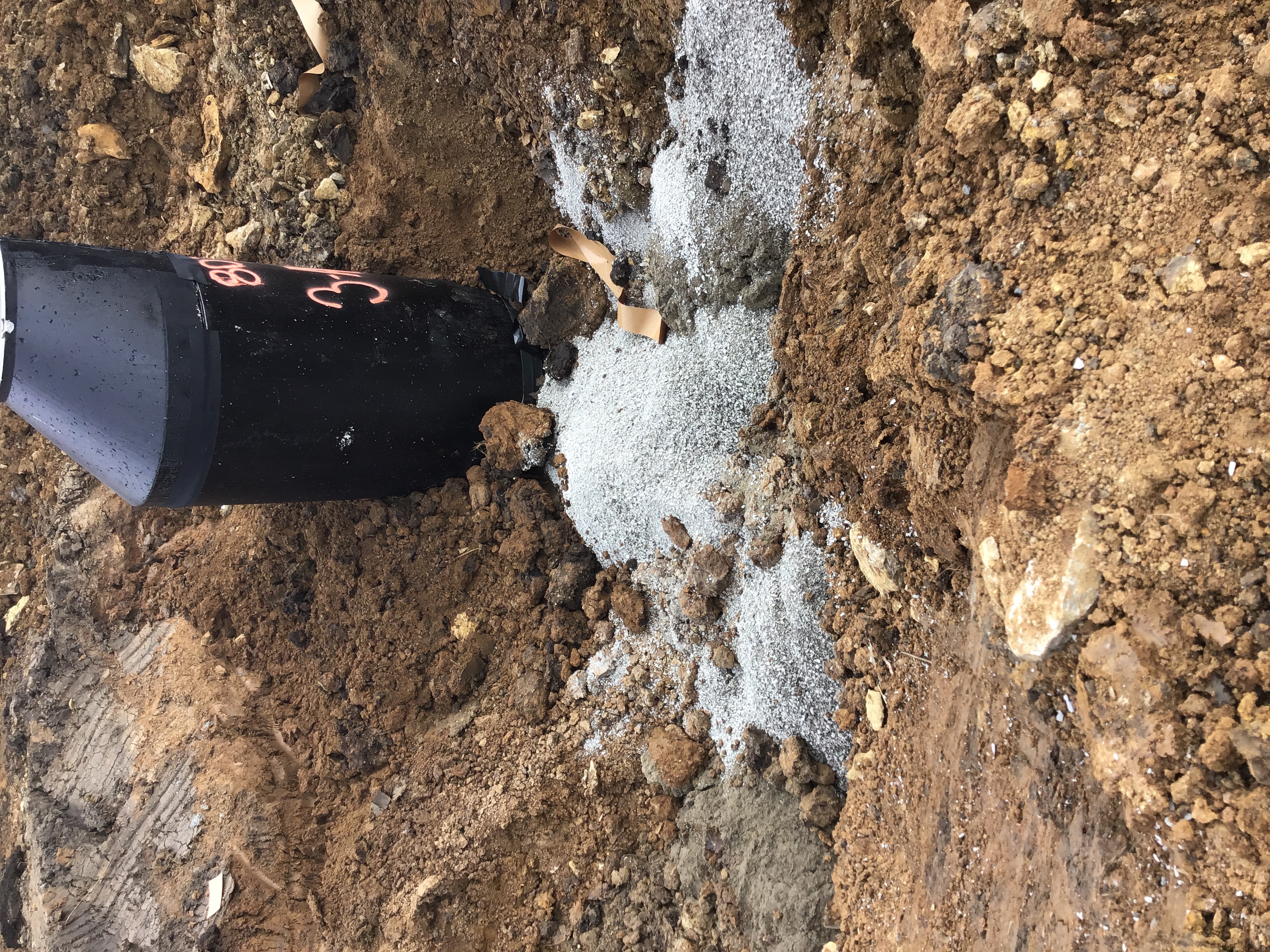

08/23/2019 Water main 3-02

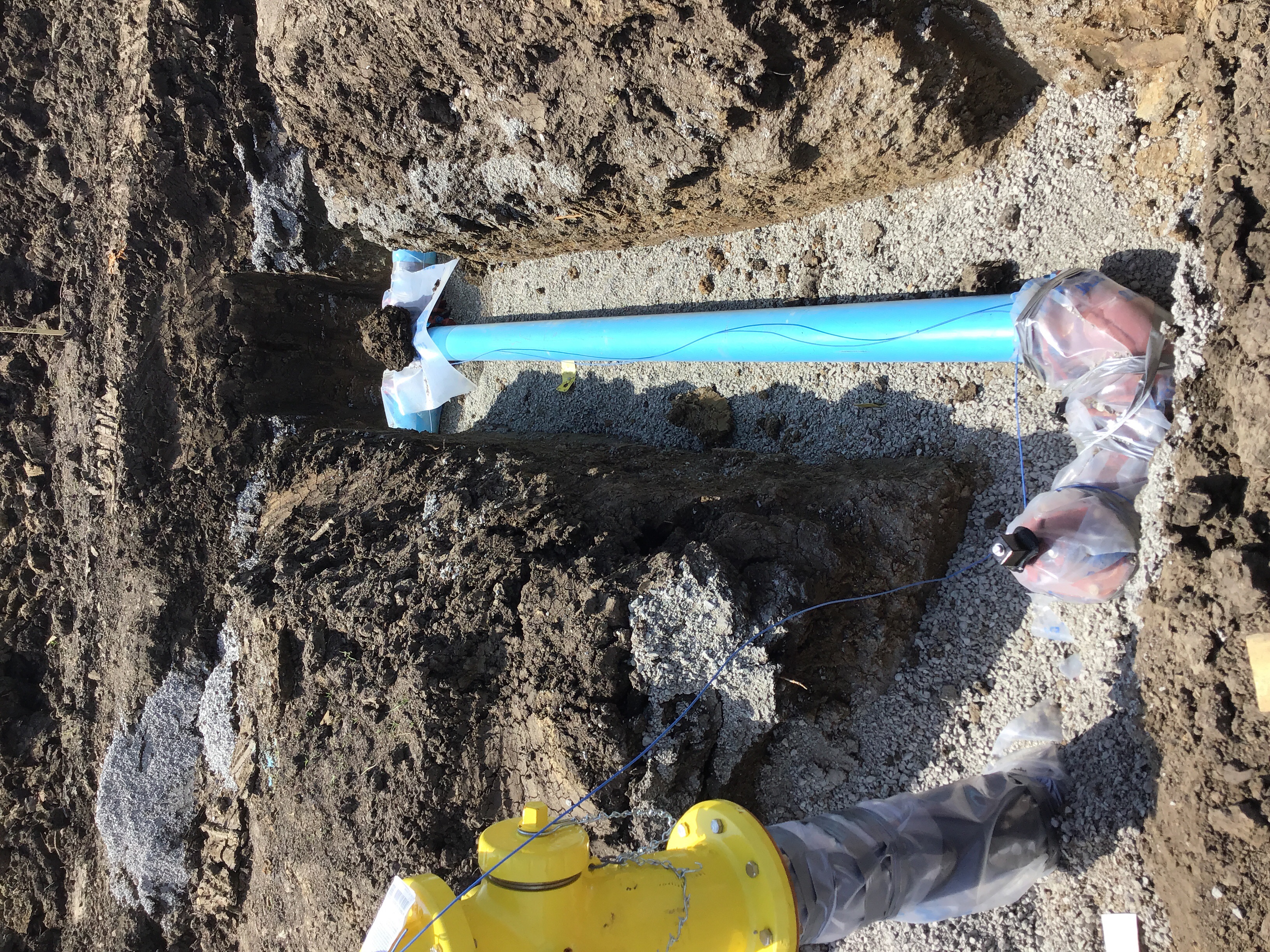

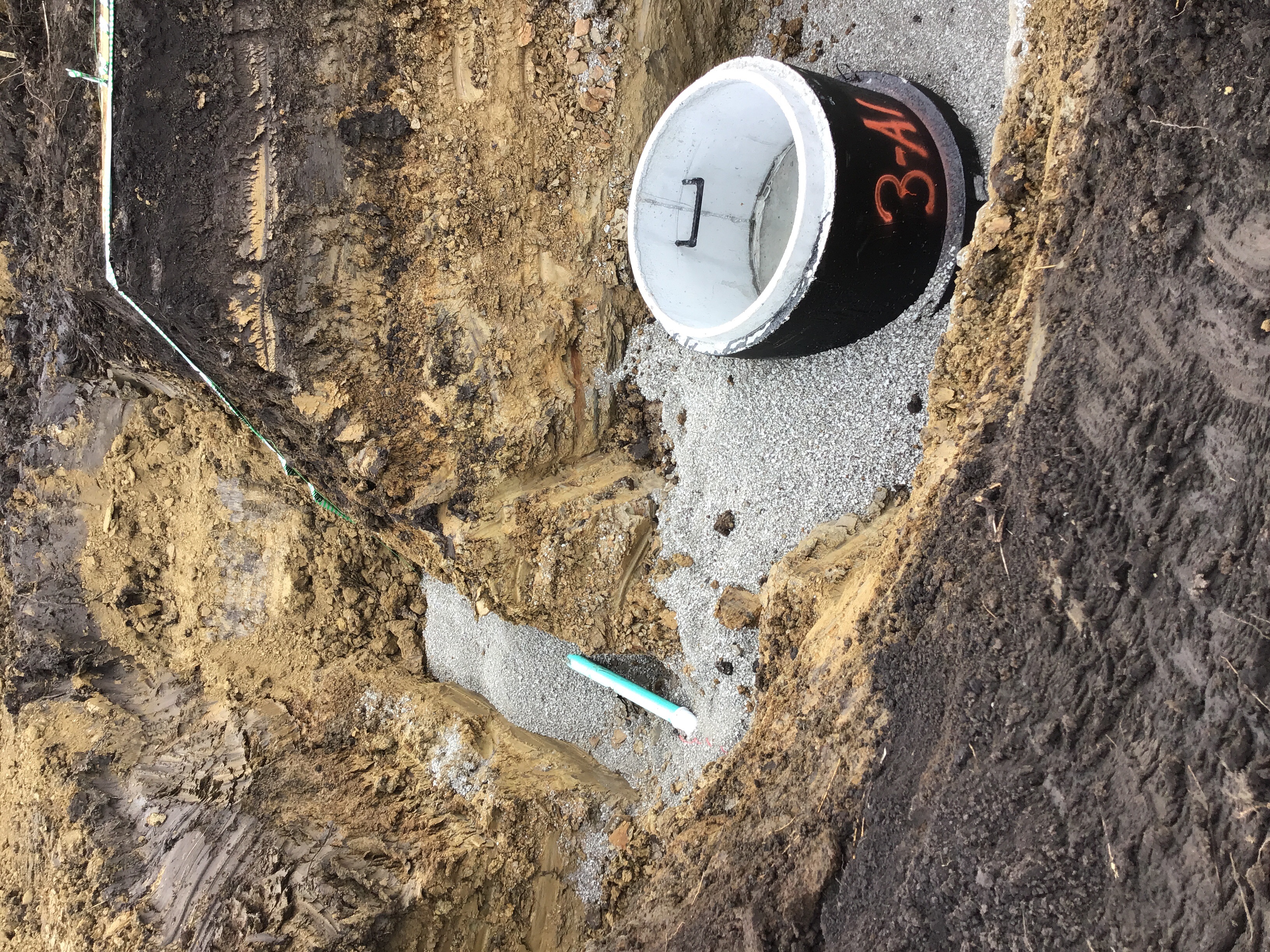

08/23/2019 Water main 3-3
07/26/2019 Letter INSPECTION SUMMARY

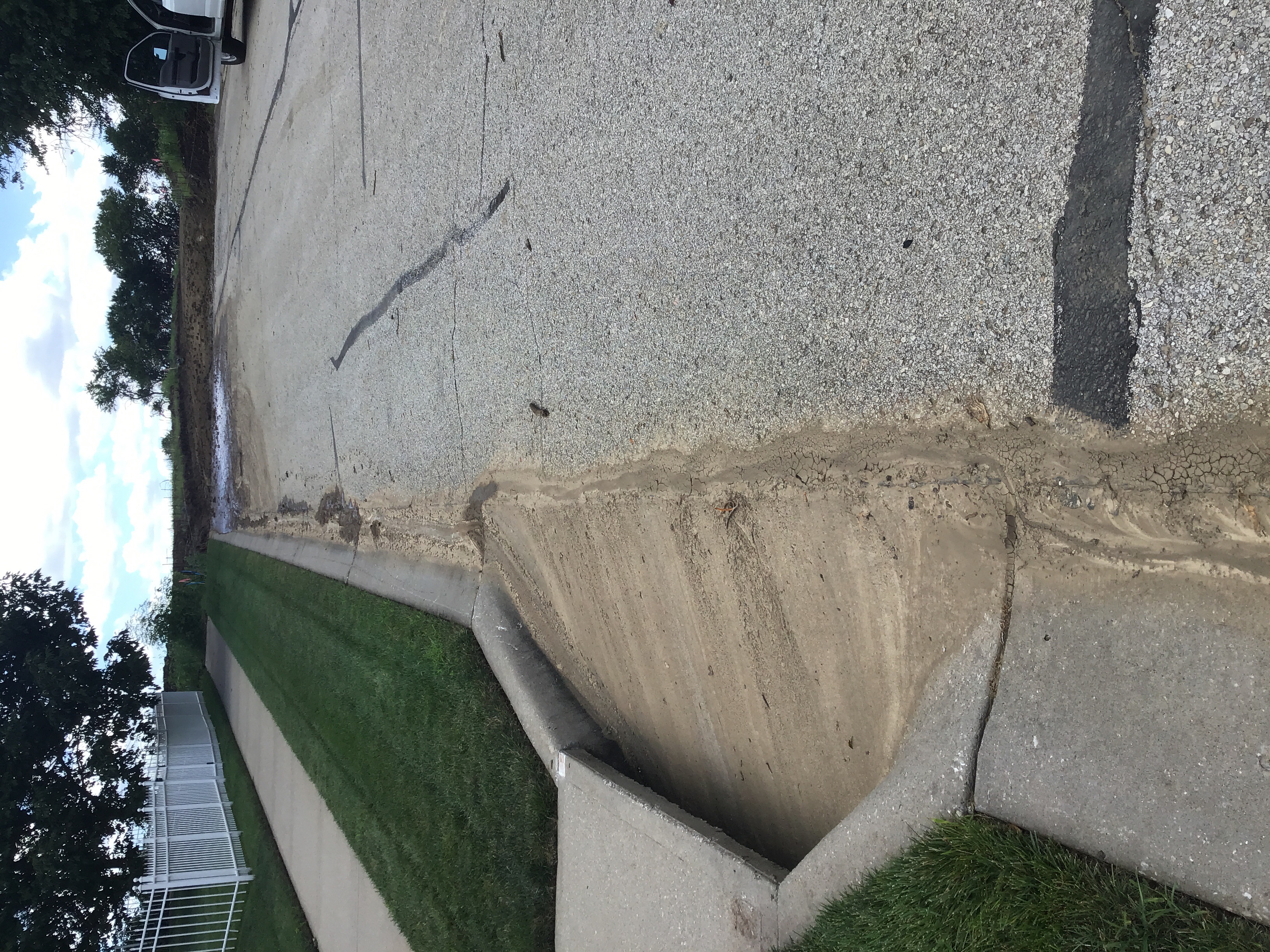

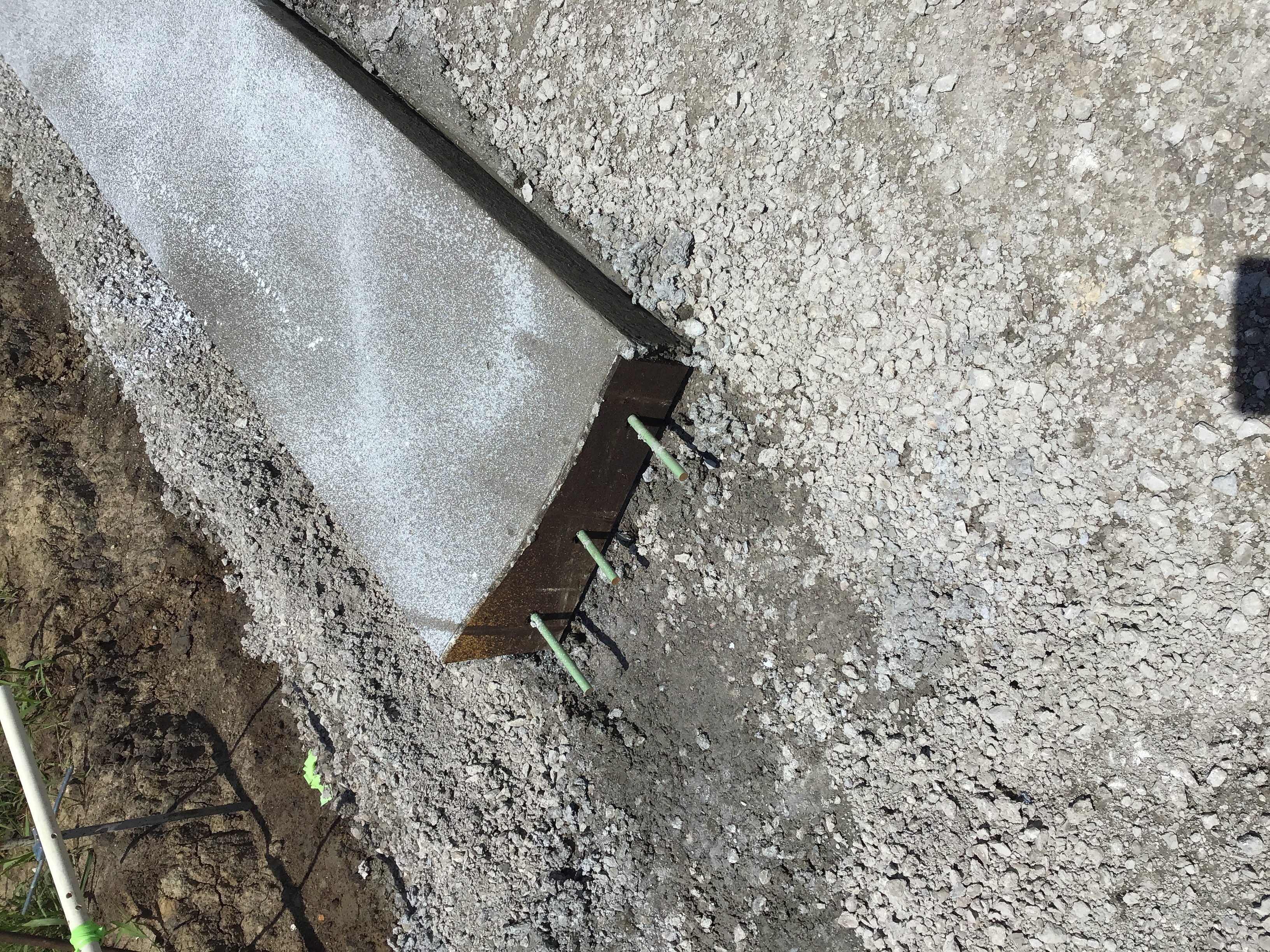

07/29/2019 Curb
07/29/2019 Curb0
07/29/2019 Curb1
07/29/2019 Letter INSPECTION SUMMARY
07/30/2019 Letter INSPECTION SUMMARY
07/31/2019 Letter INSPECTION SUMMARY
08/01/2019 Letter INSPECTION SUMMARY
08/02/2019 Letter INSPECTION SUMMARY

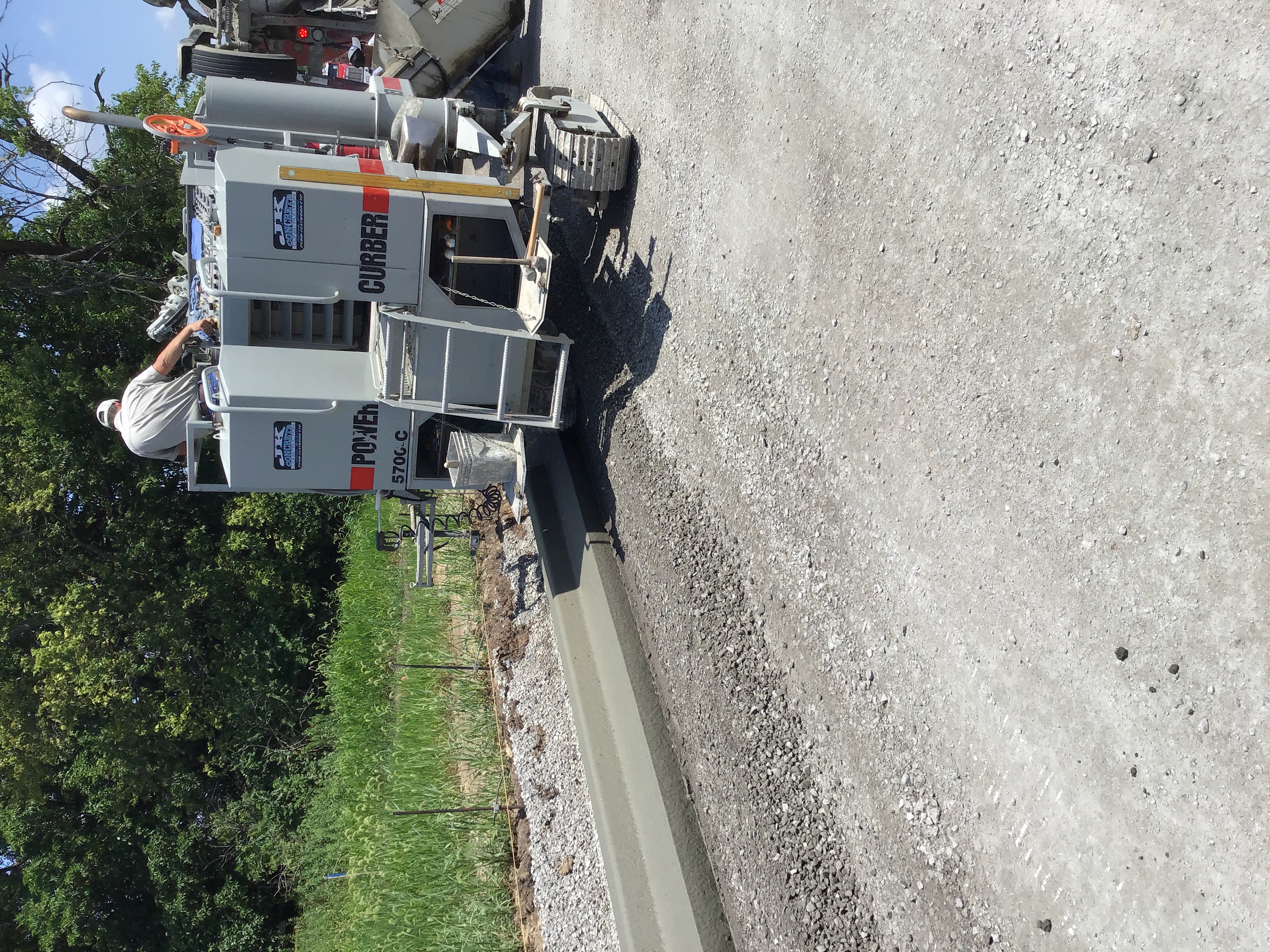

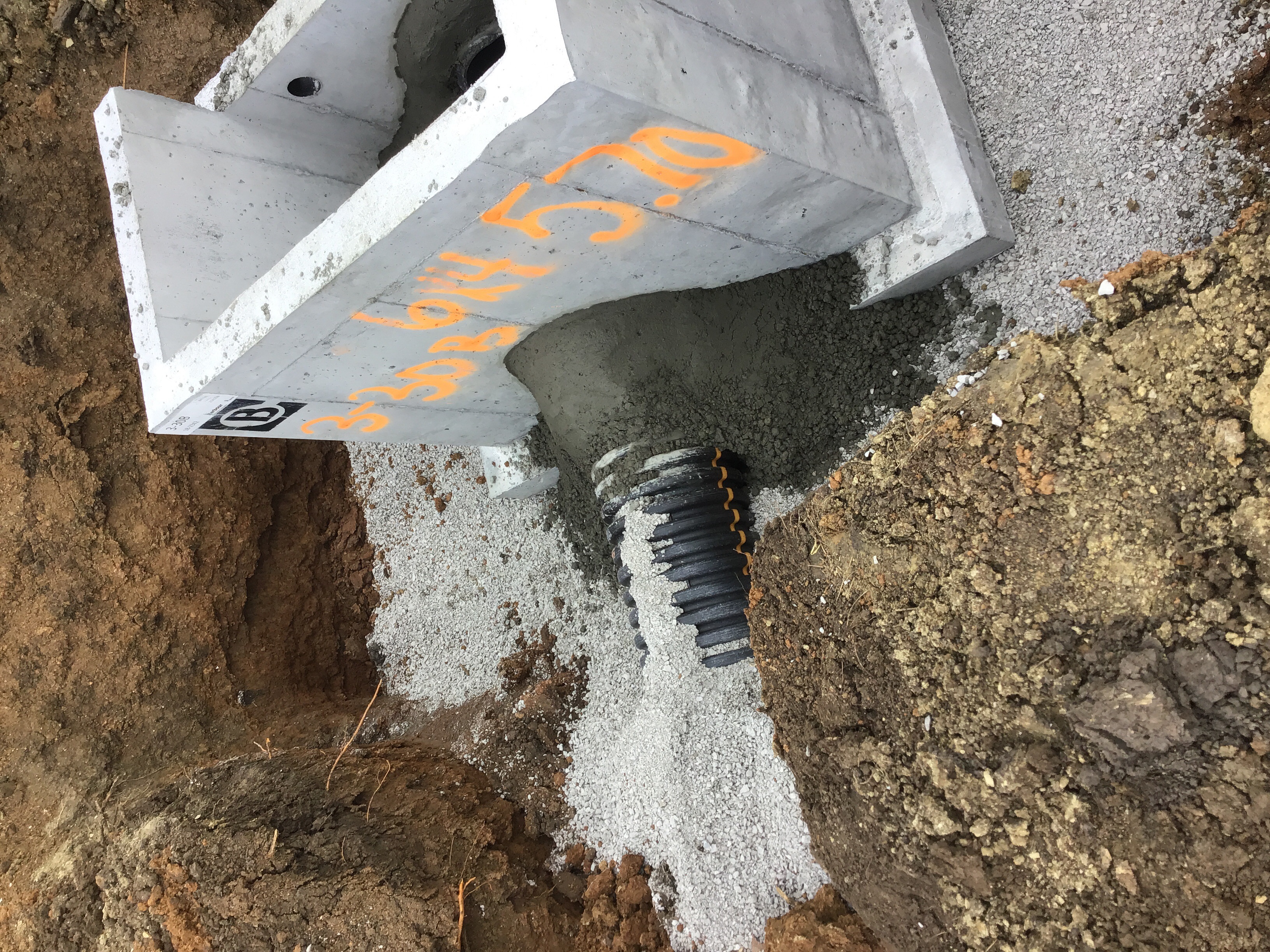

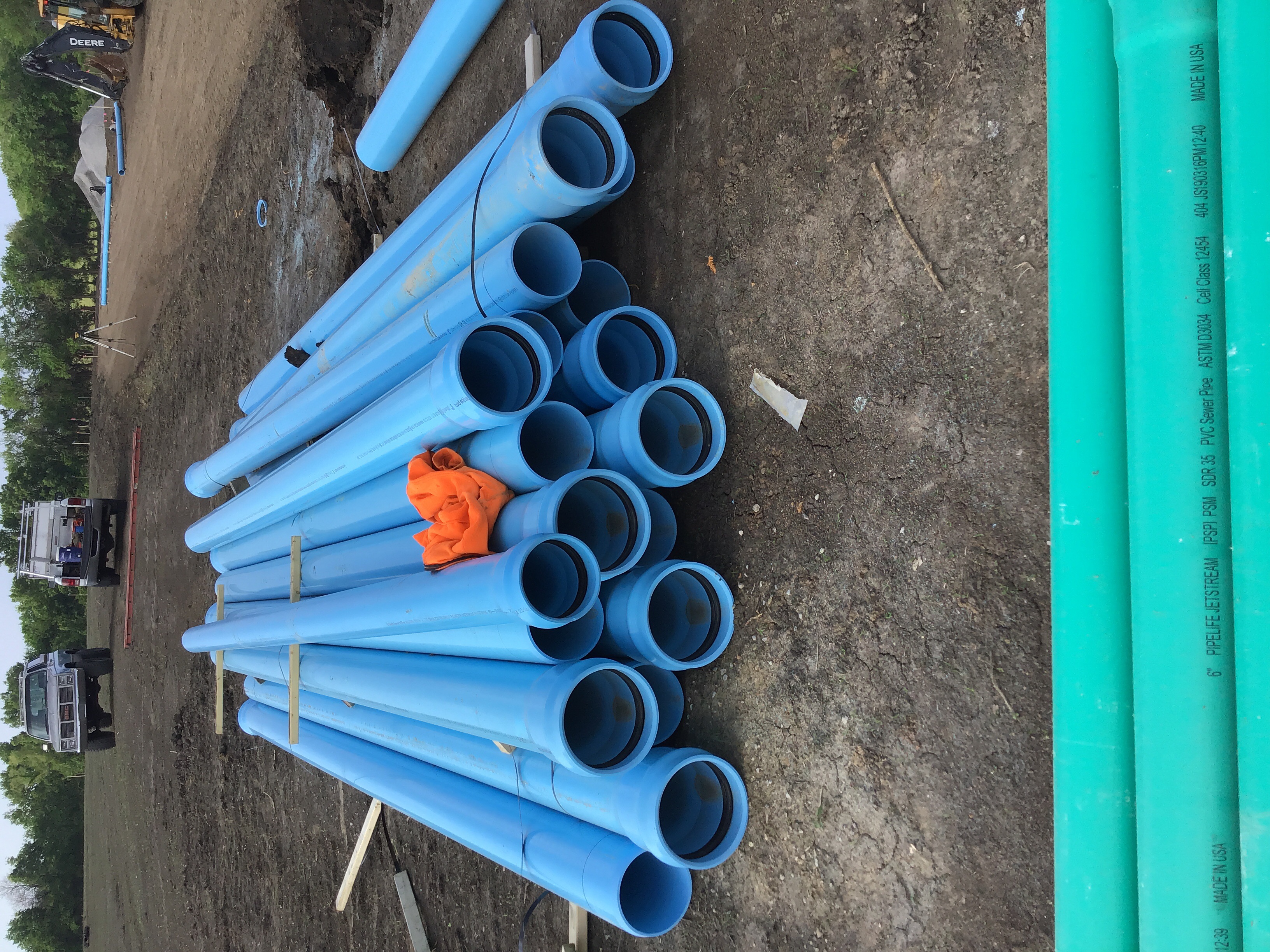

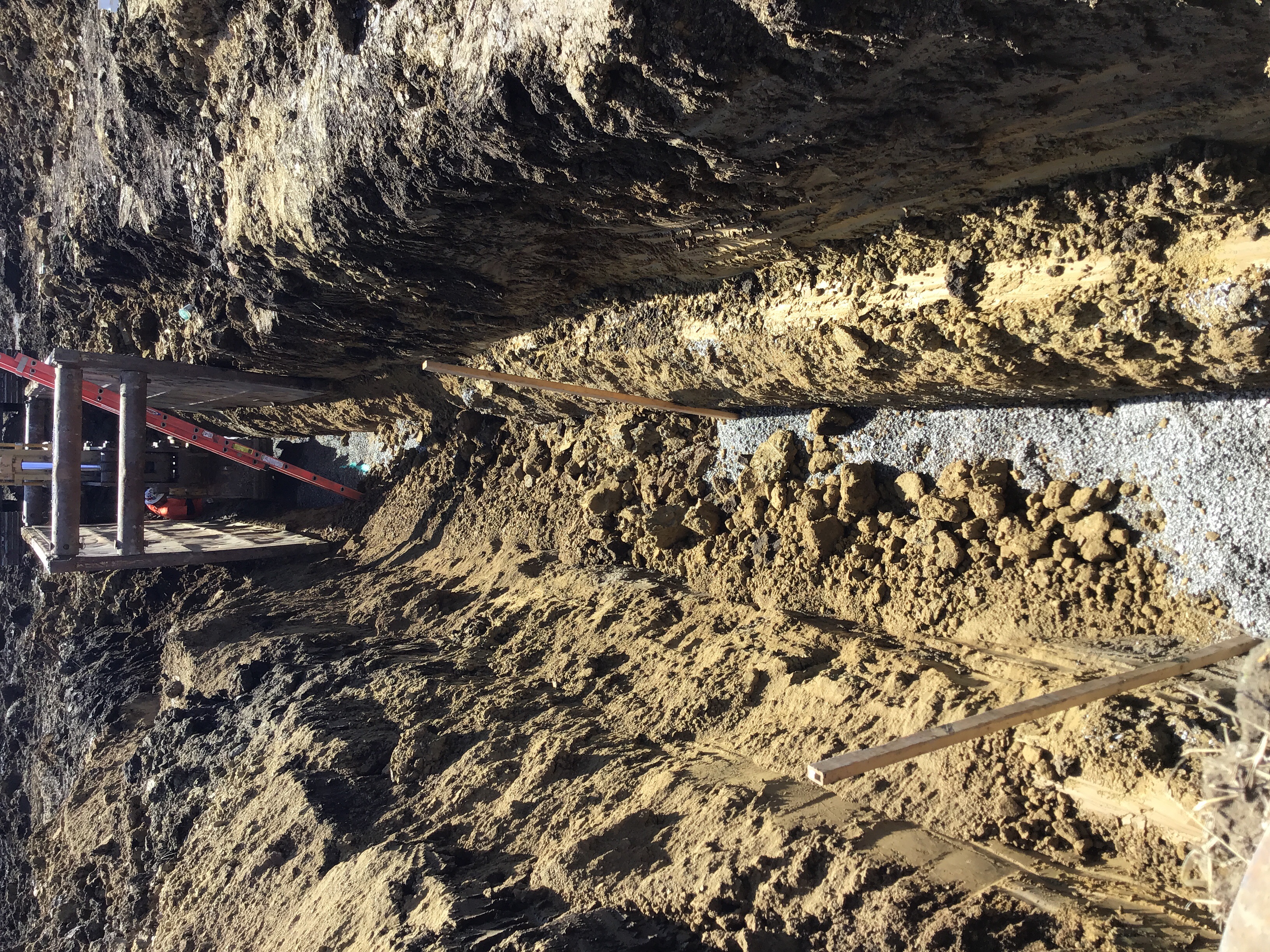

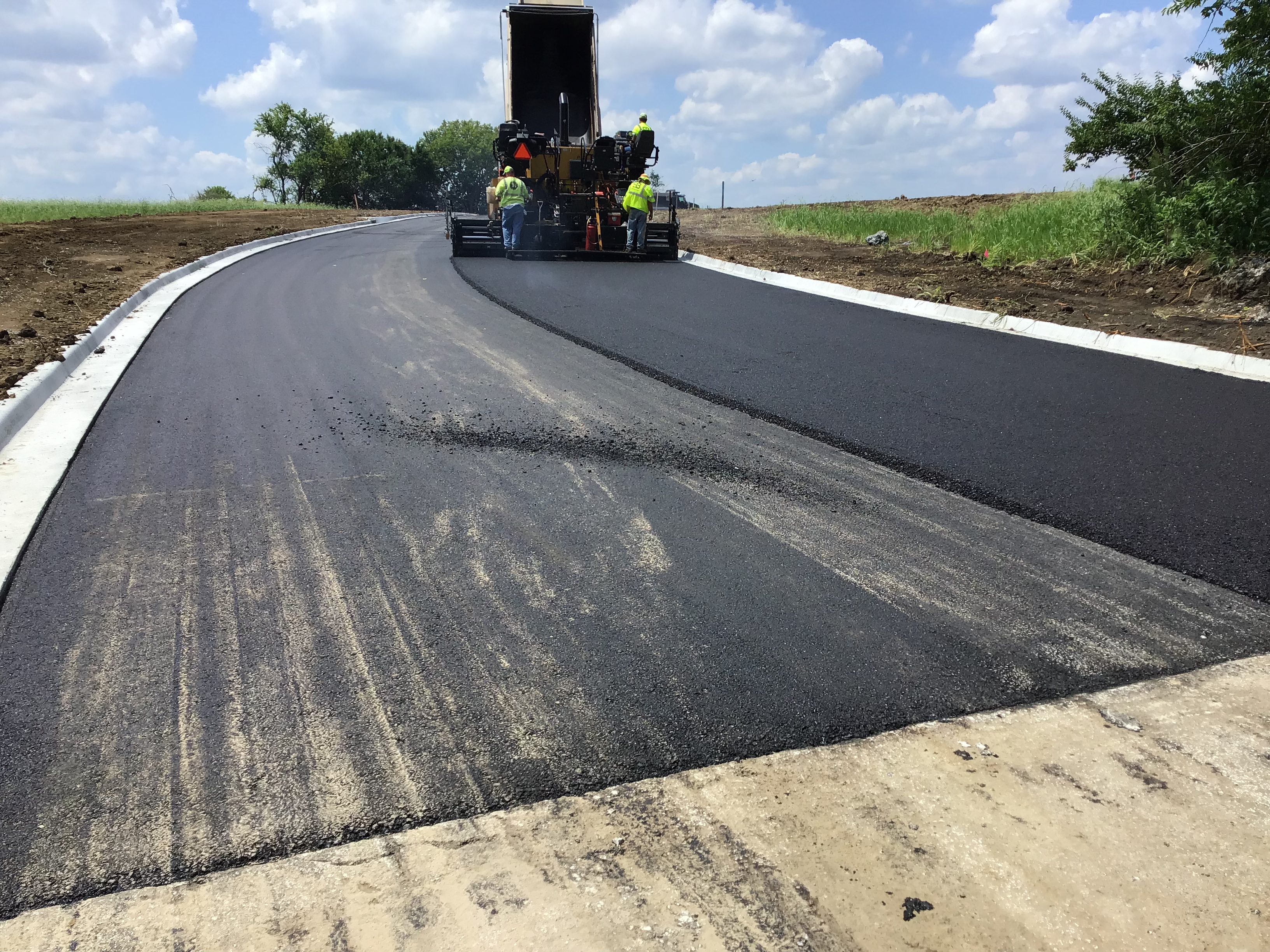

08/03/2019 Base lift
08/03/2019 Wedge lift
08/03/2019 Surface lift
08/03/2019 Surface lift0
08/03/2019 Letter INSPECTION SUMMARY
08/03/2019 Letter INSPECTION SUMMARY
08/03/2019 Letter INSPECTION SUMMARY
08/20/2019 Letter INSPECTION SUMMARY
08/20/2019 Letter INSPECTION SUMMARY
08/23/2019 image96
08/23/2019 Letter INSPECTION SUMMARY
08/19/2019 Letter INSPECTION SUMMARY
08/27/2019 Letter INSPECTION SUMMARY
08/27/2019 Letter INSPECTION SUMMARY
09/20/2019 Letter INSPECTION SUMMARY
08/29/2019 Letter INSPECTION SUMMARY
10/21/2019 Letter INSPECTION SUMMARY
08/29/2019 Letter INSPECTION SUMMARY
09/03/2019 Letter INSPECTION SUMMARY
12/16/2019 Summit View Farms 3rd Plat Signed Certificate of Substantial Completion
12/16/2019 Summit View Farms 3rd Plat Signed Punch List

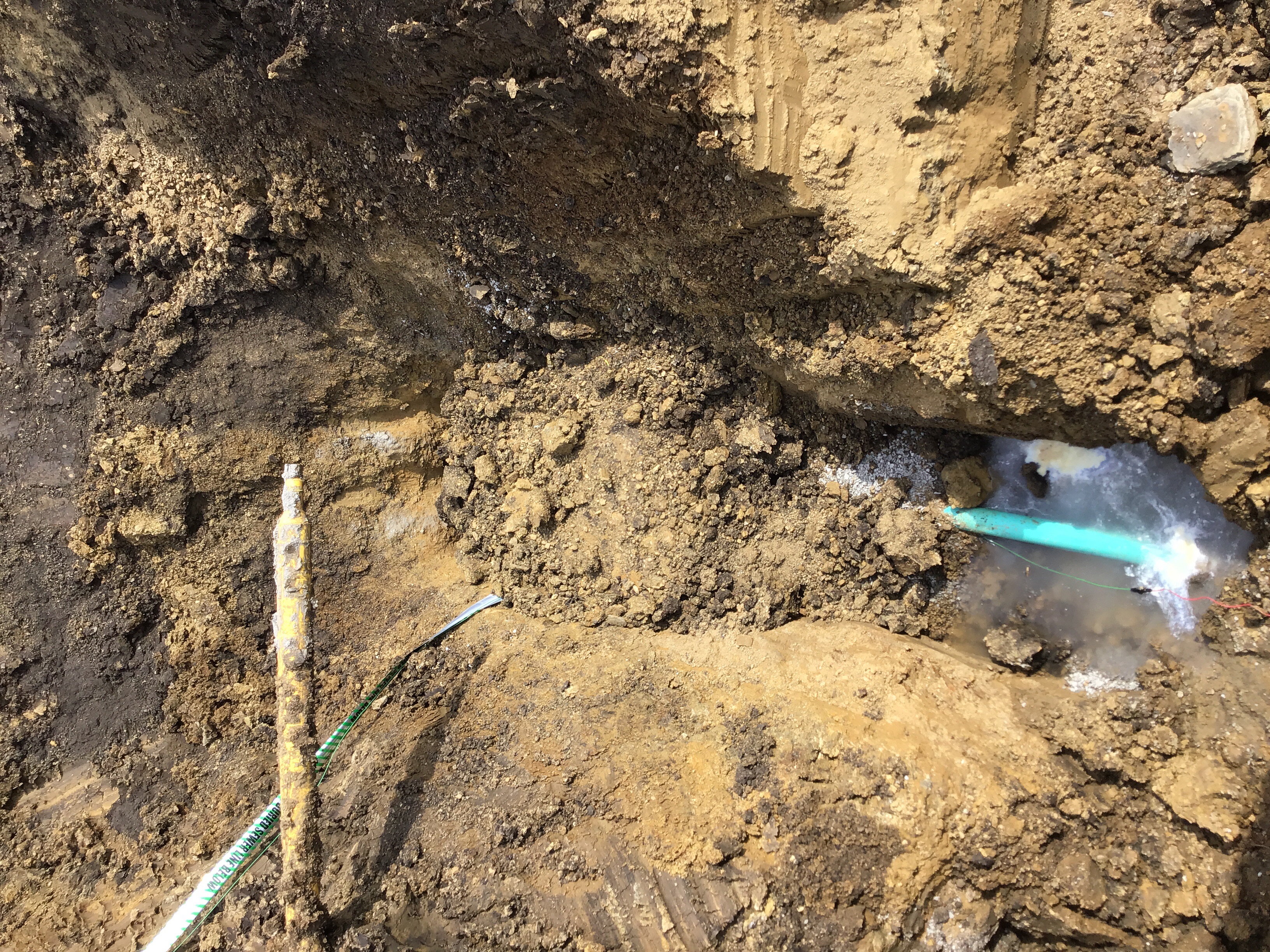

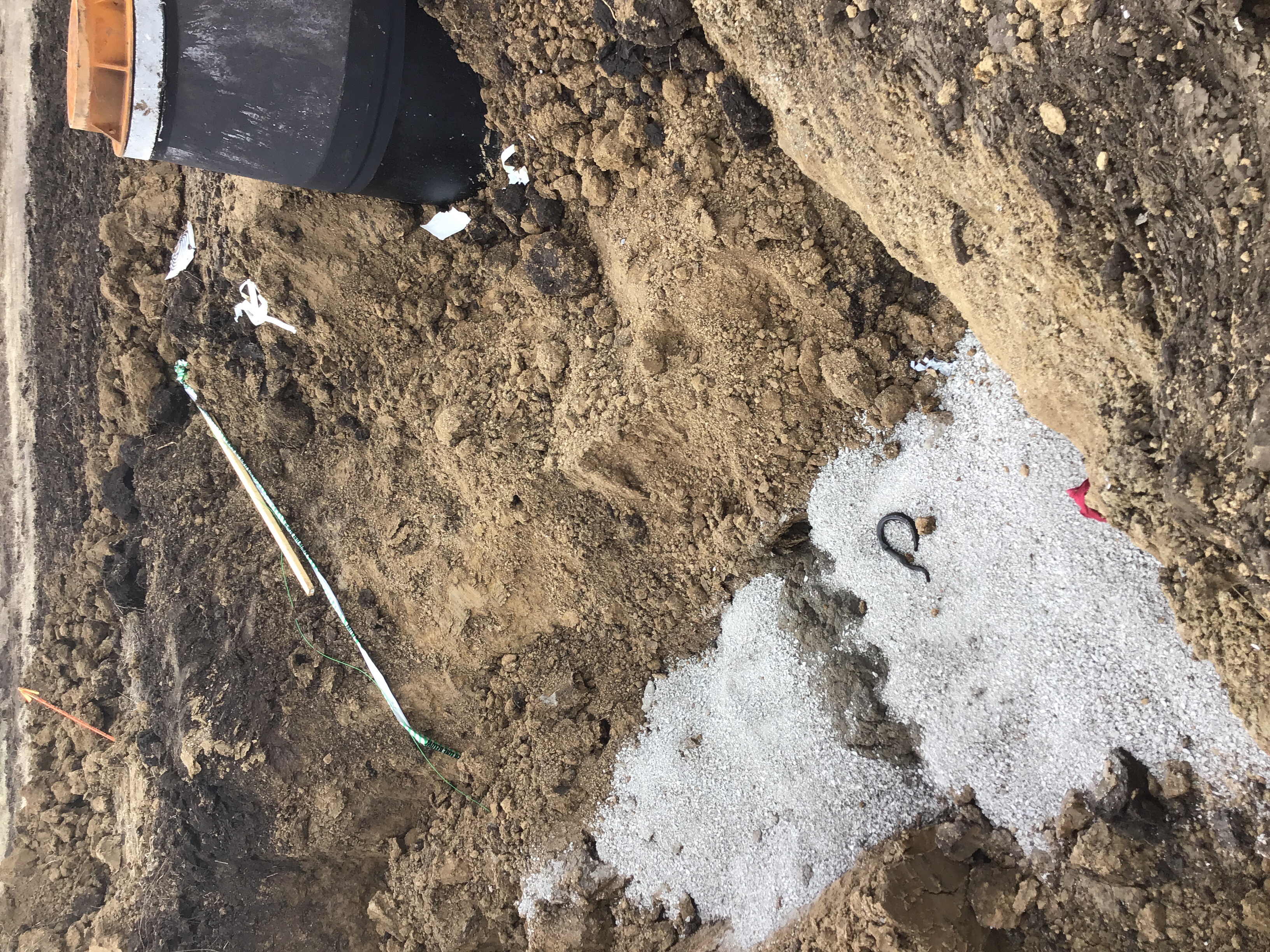

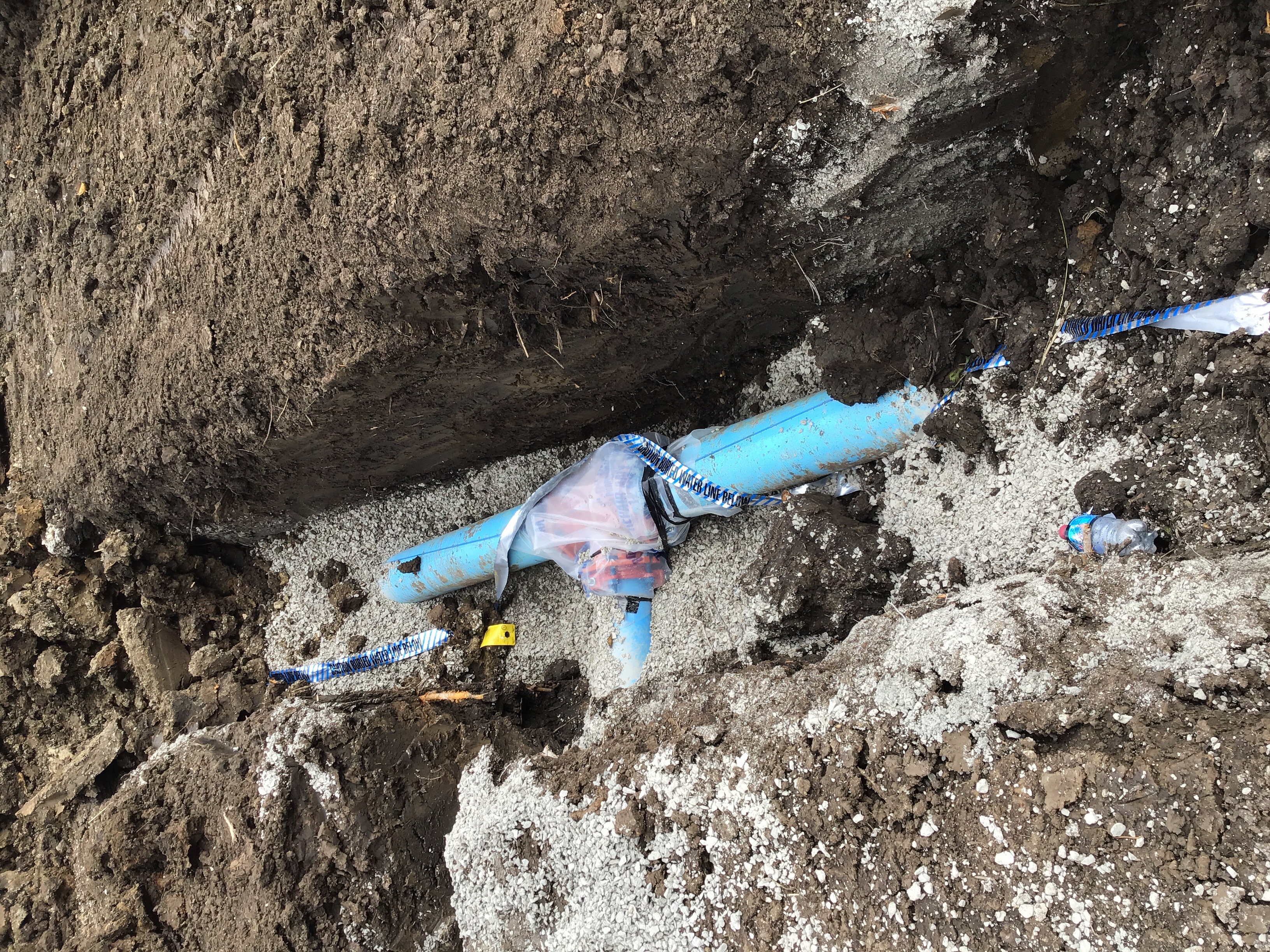

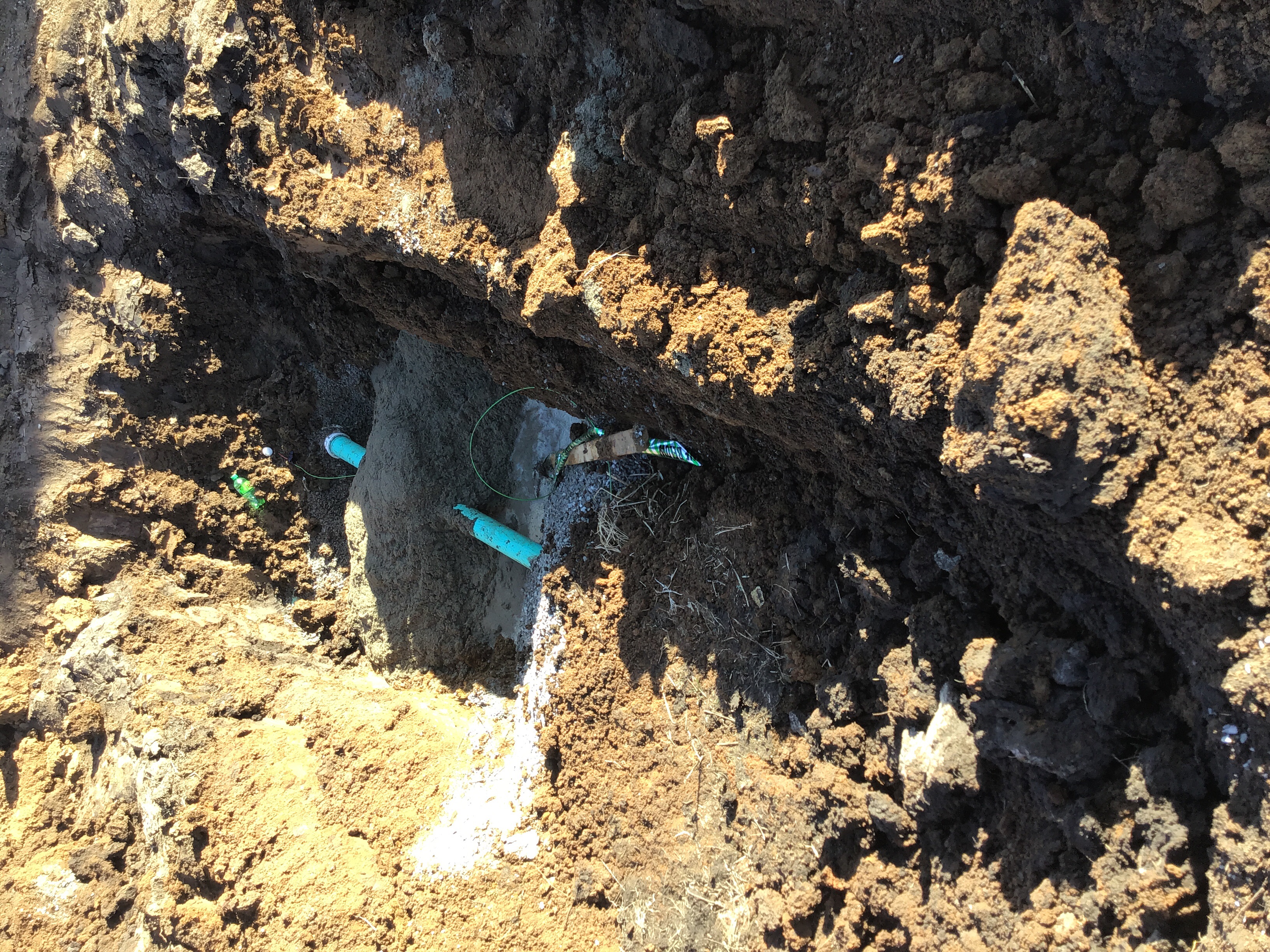

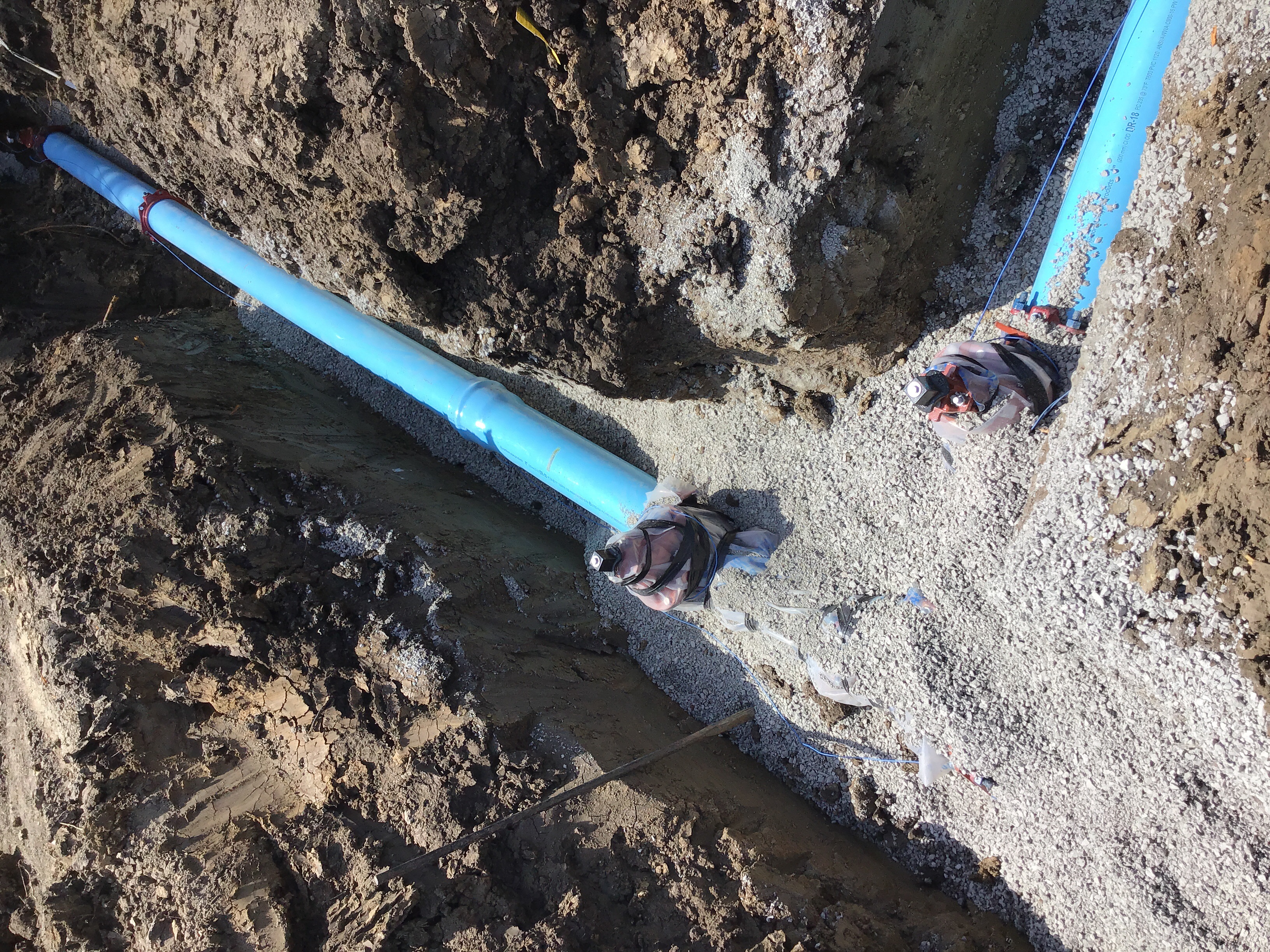

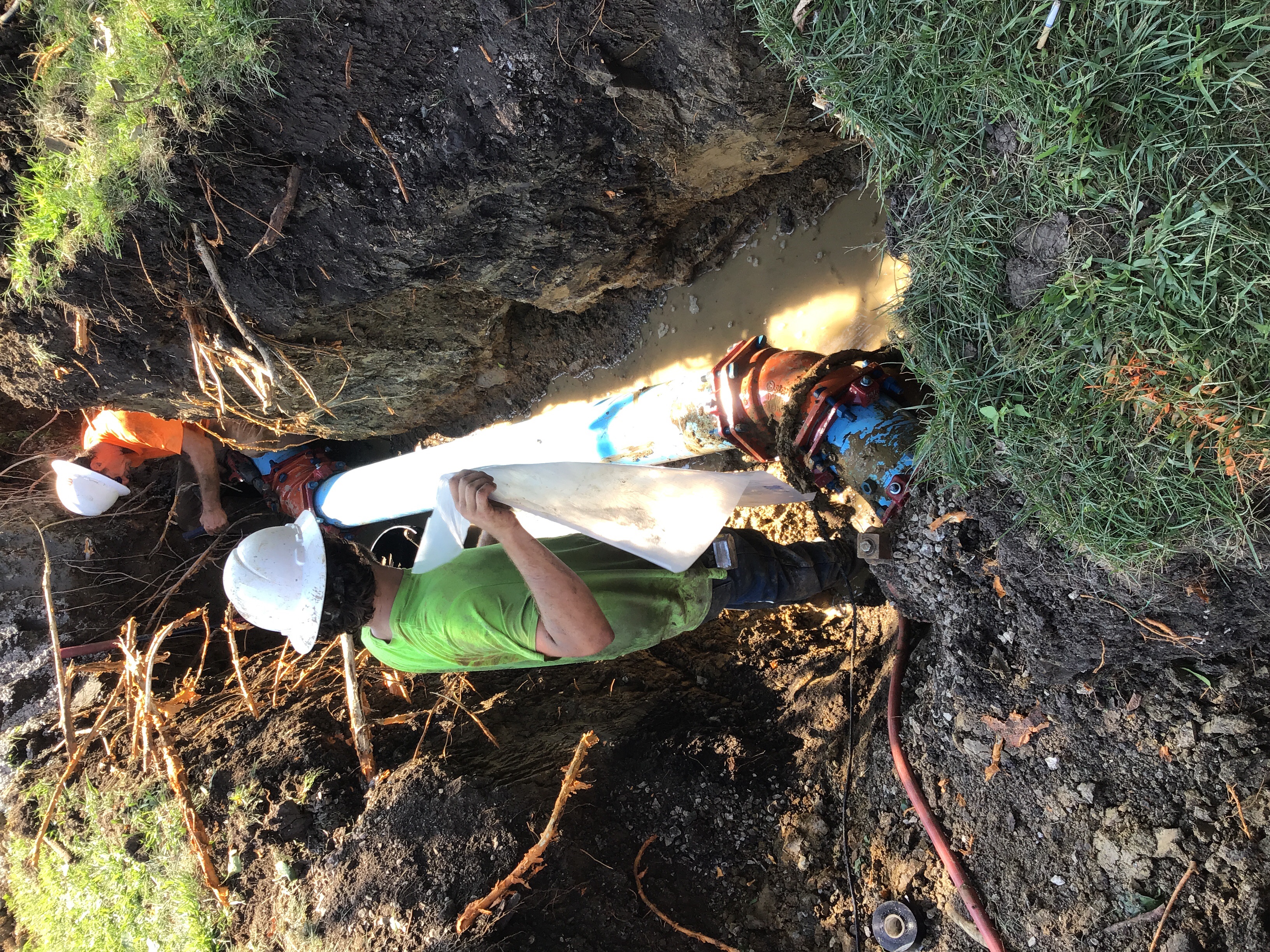

09/03/2019 Water line Kline
09/03/2019 Letter INSPECTION SUMMARY
09/05/2019 Letter INSPECTION SUMMARY
09/05/2019 Letter INSPECTION SUMMARY

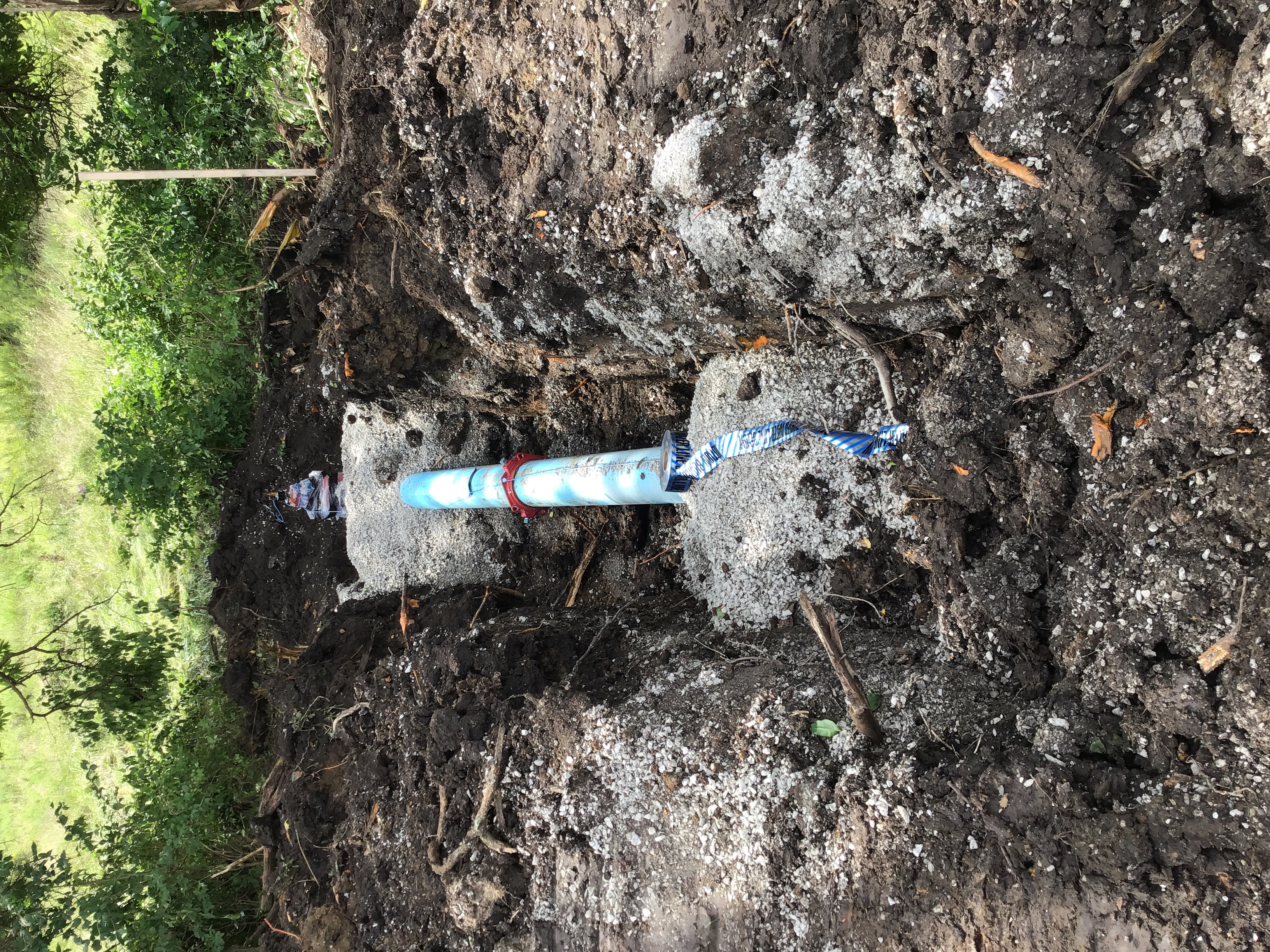

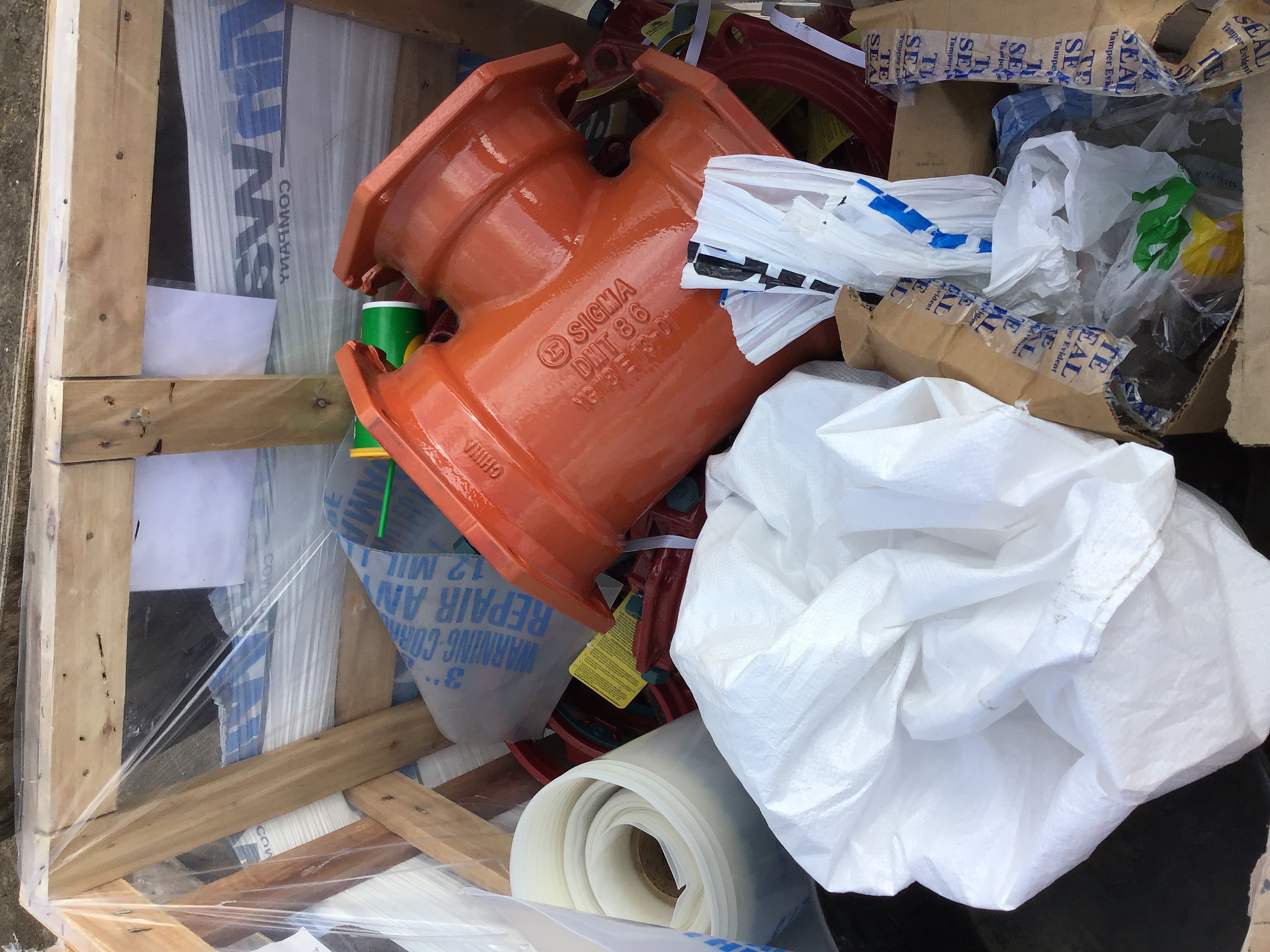

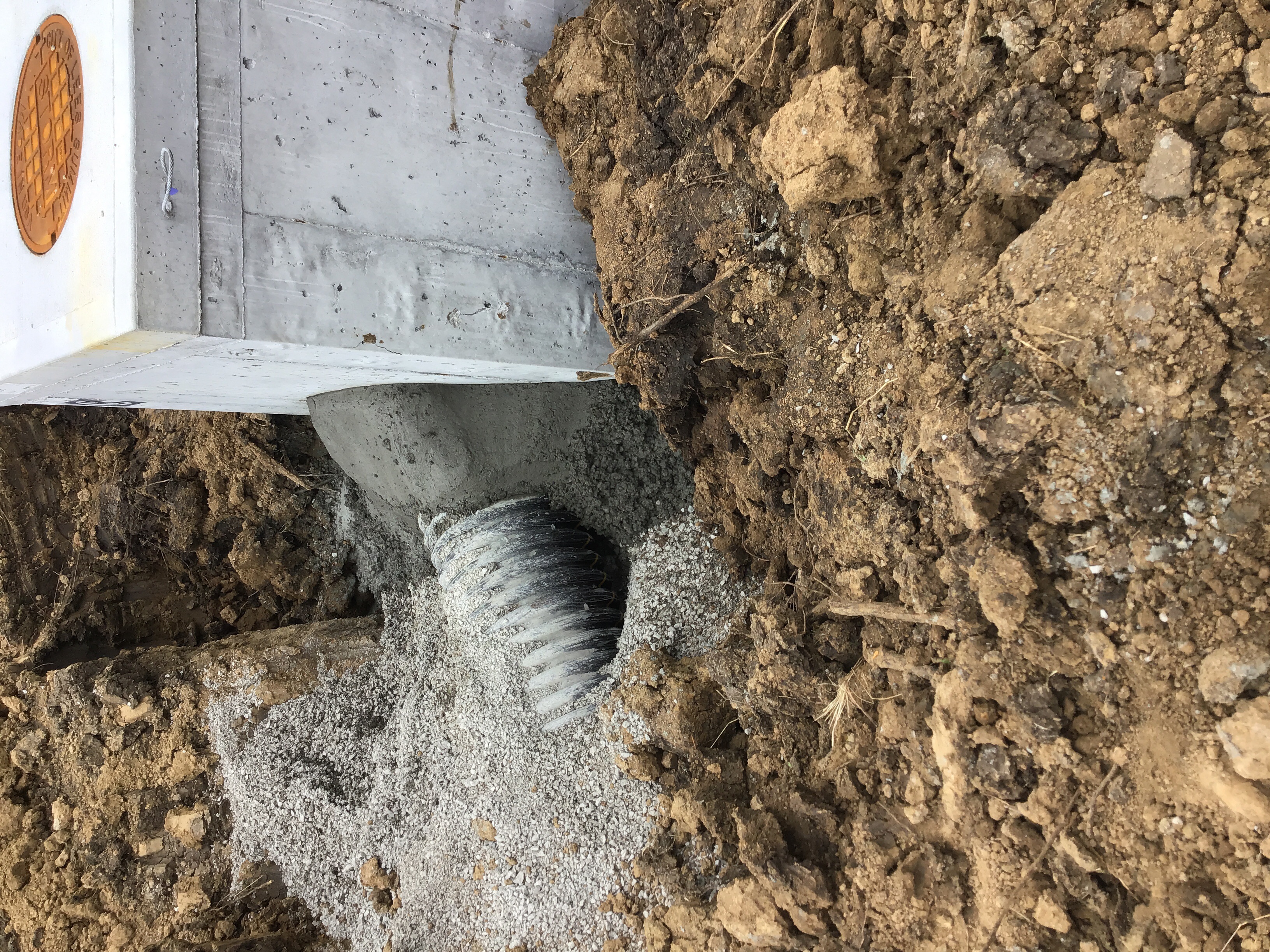

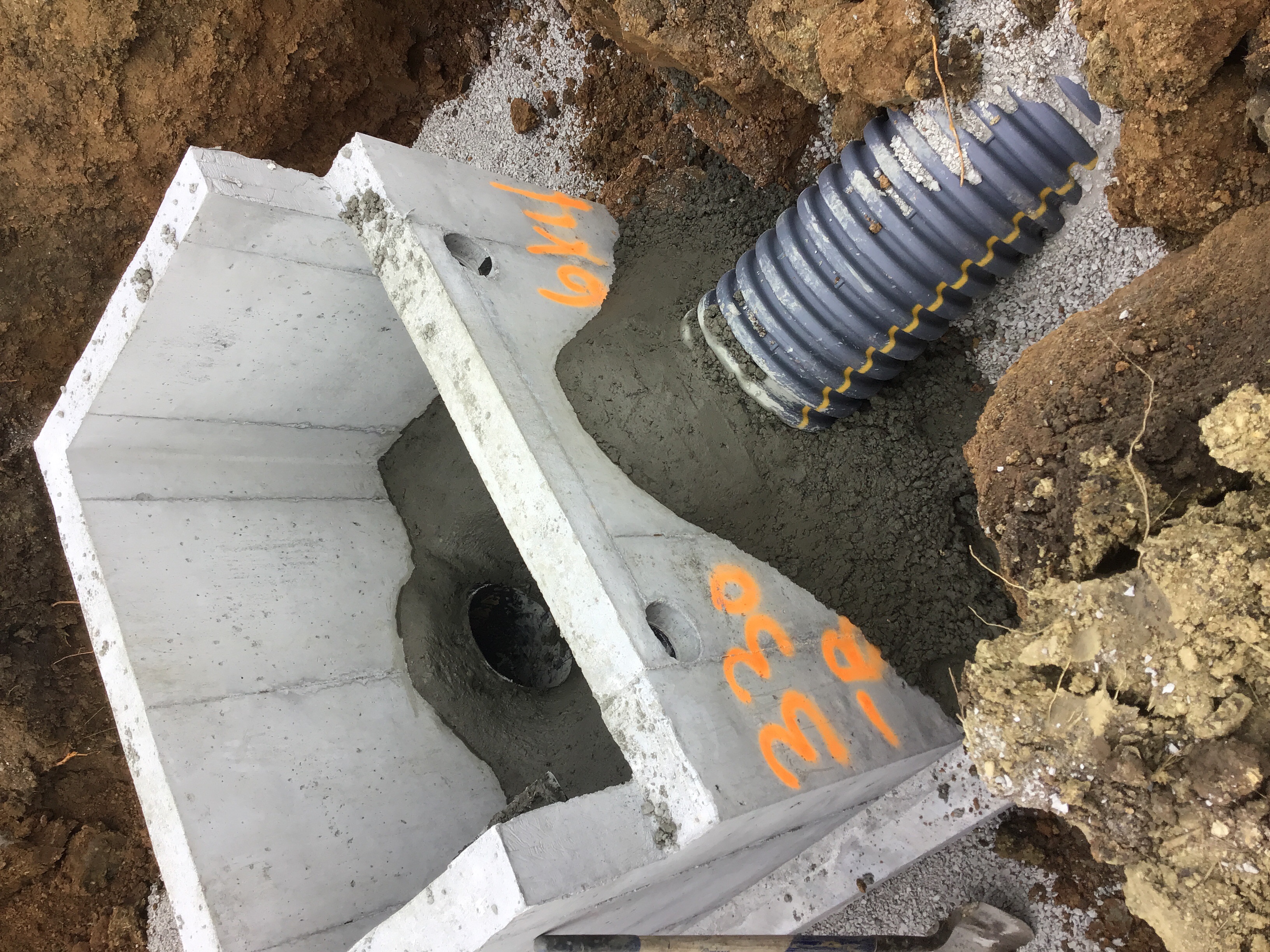

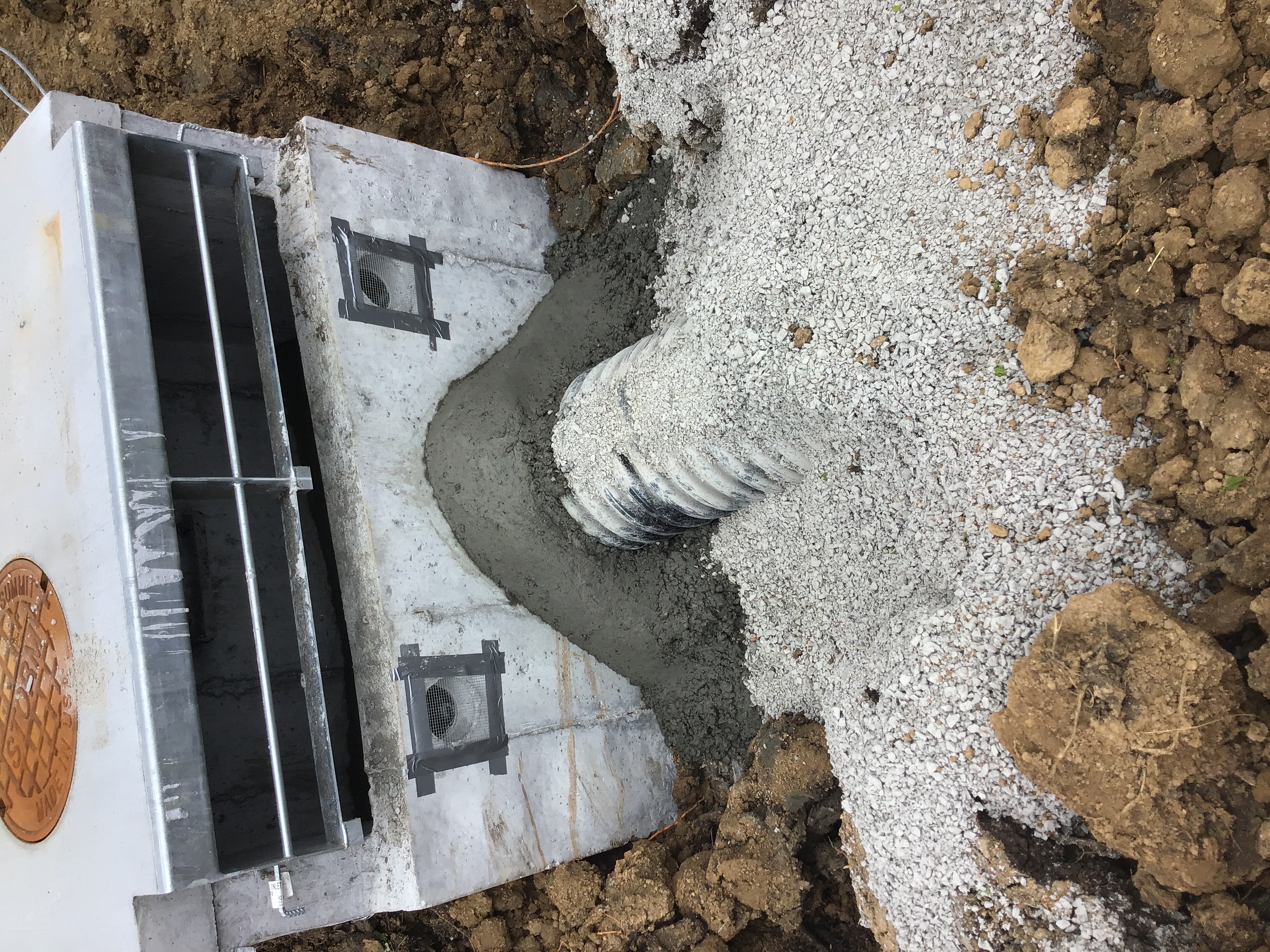

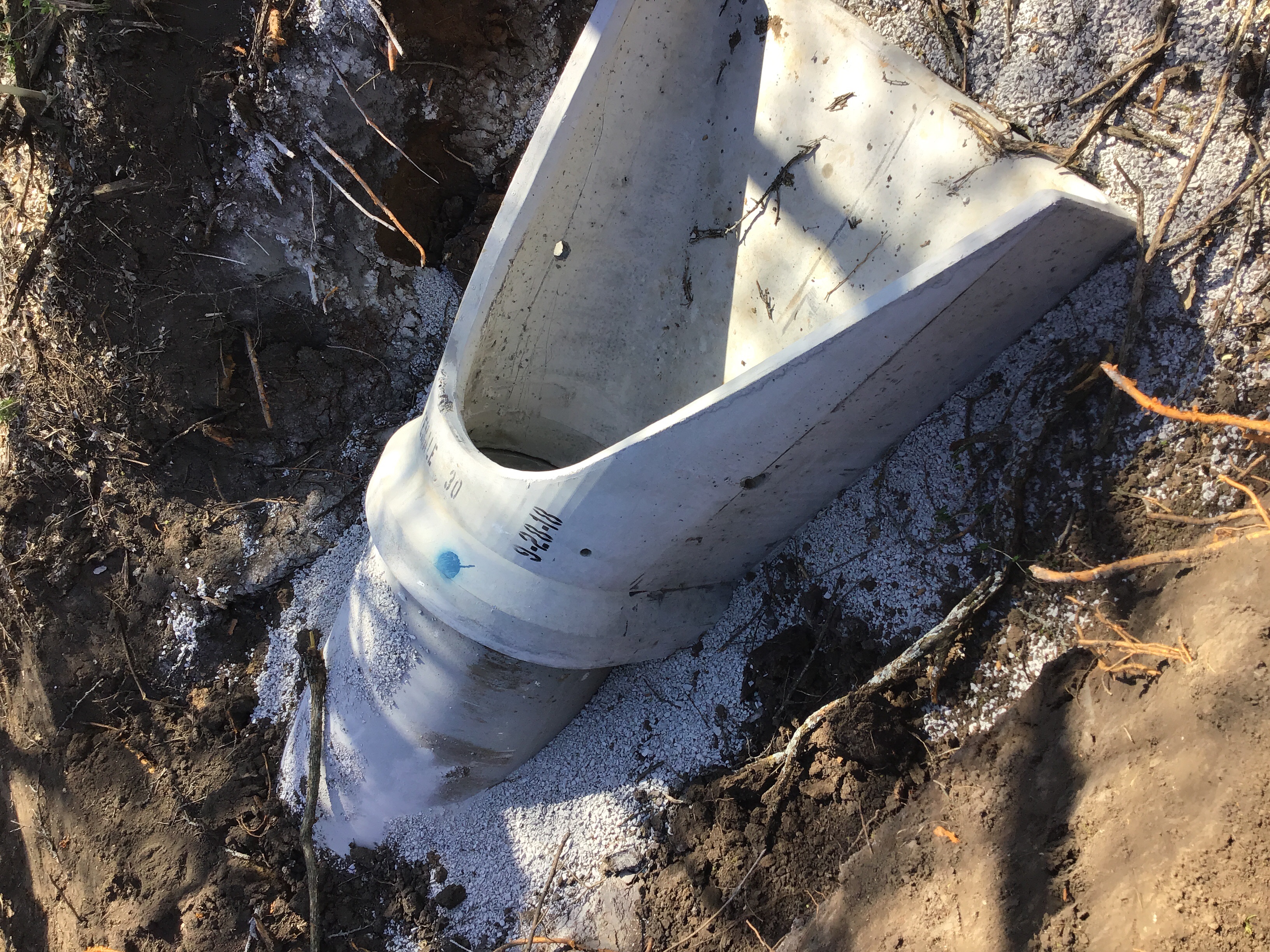

09/05/2019 Storm Materials for revised section
09/05/2019 Storm Materials revised section

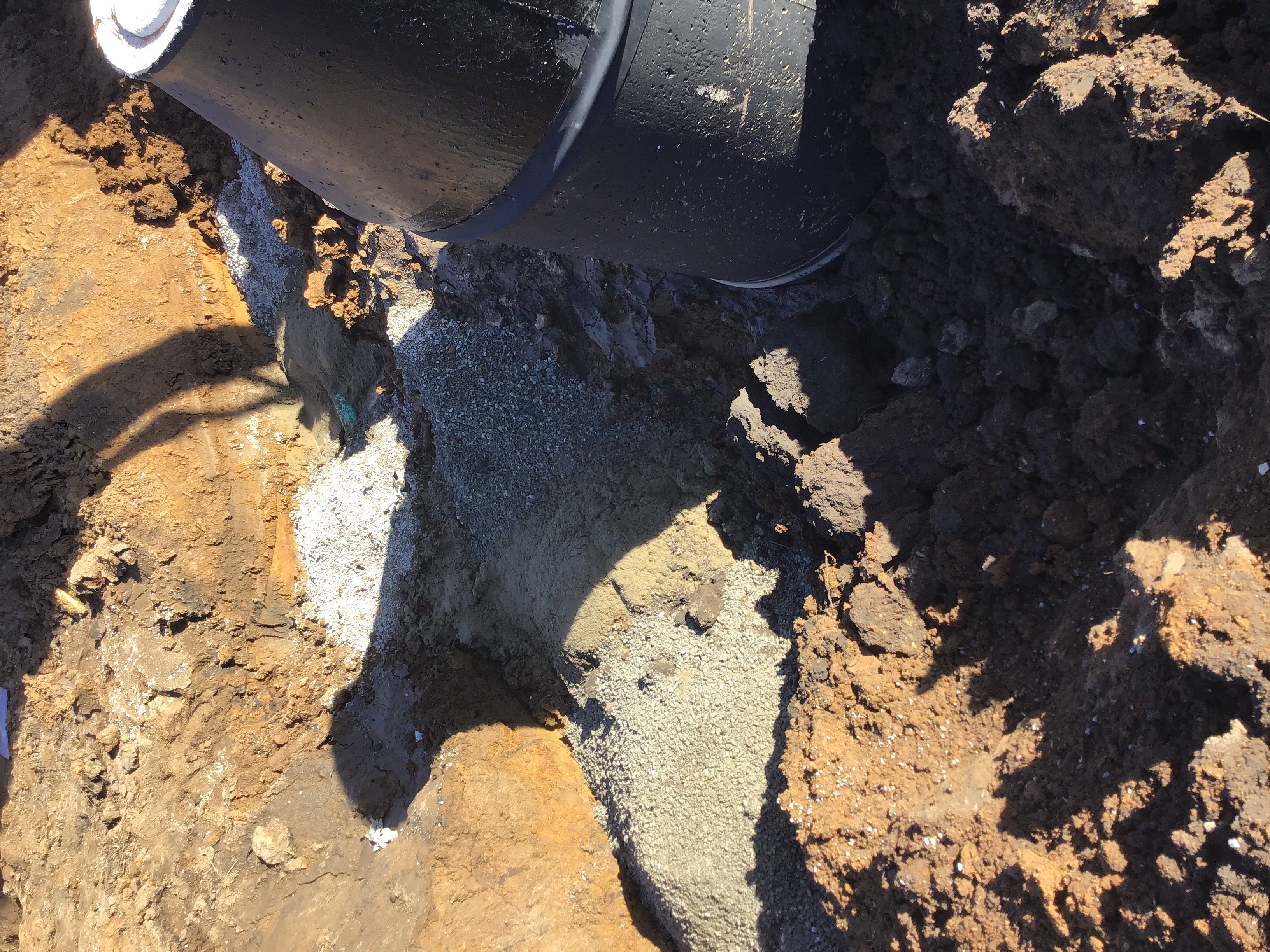

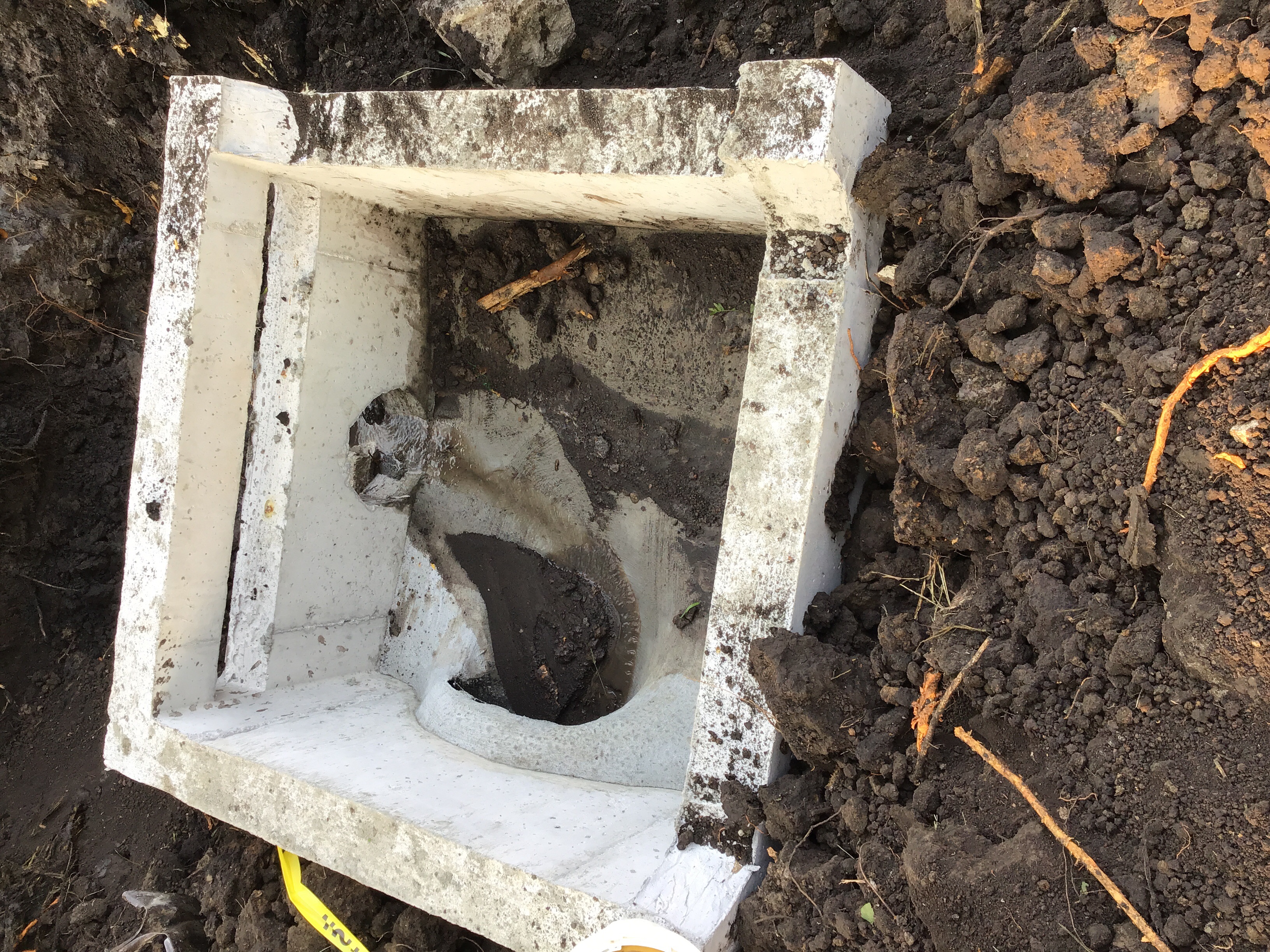

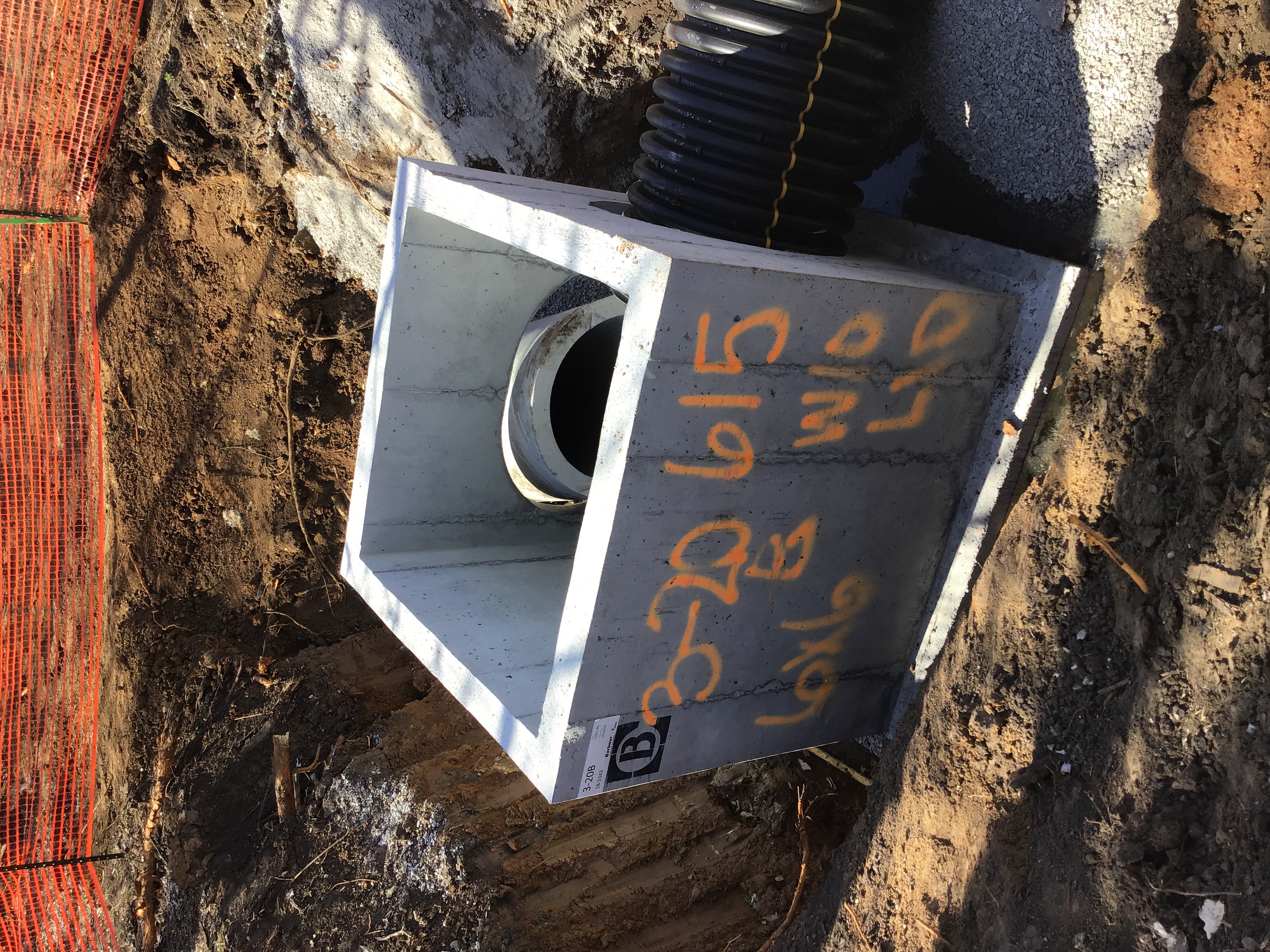

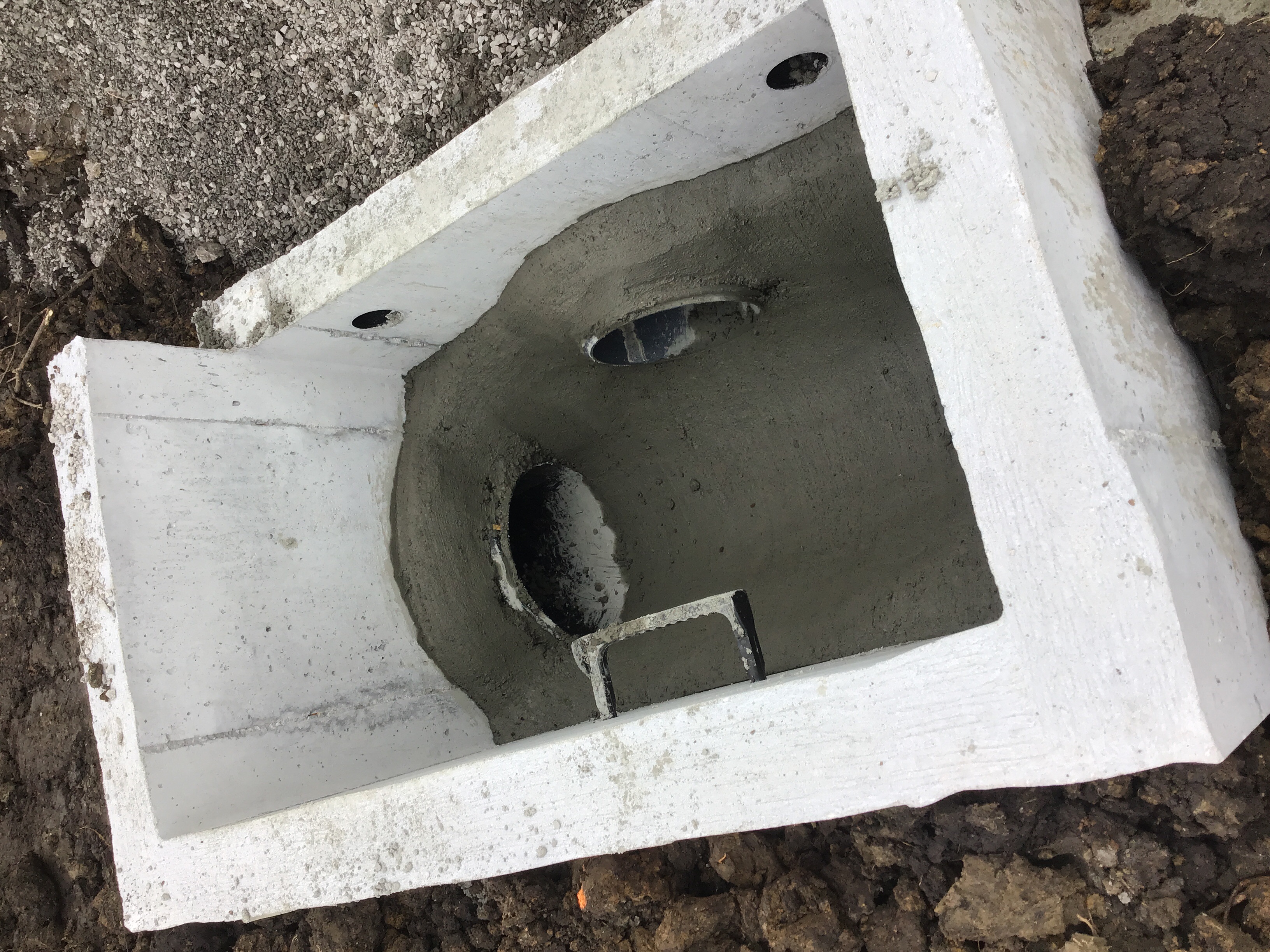

09/05/2019 Storm Pipe installed

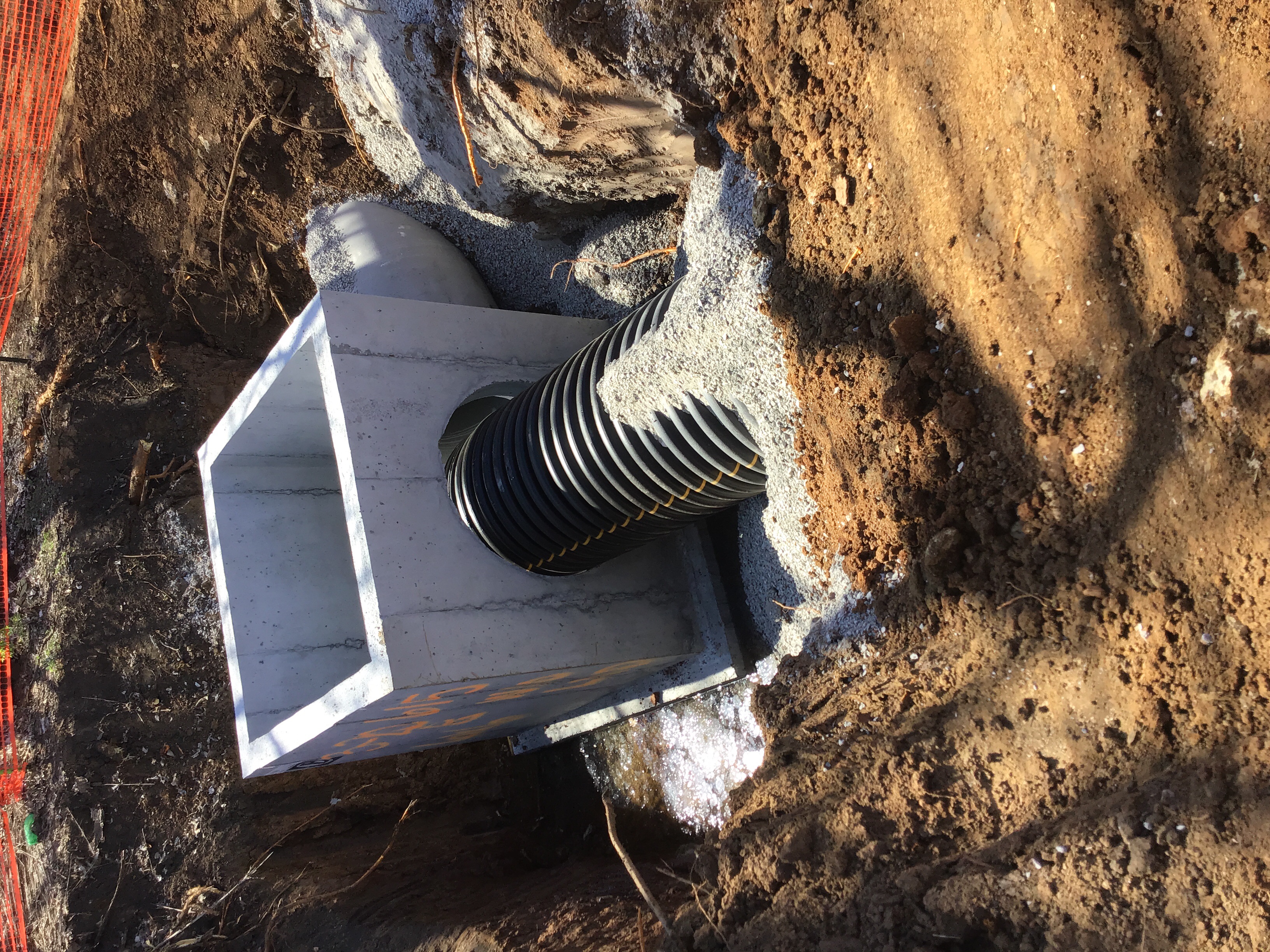

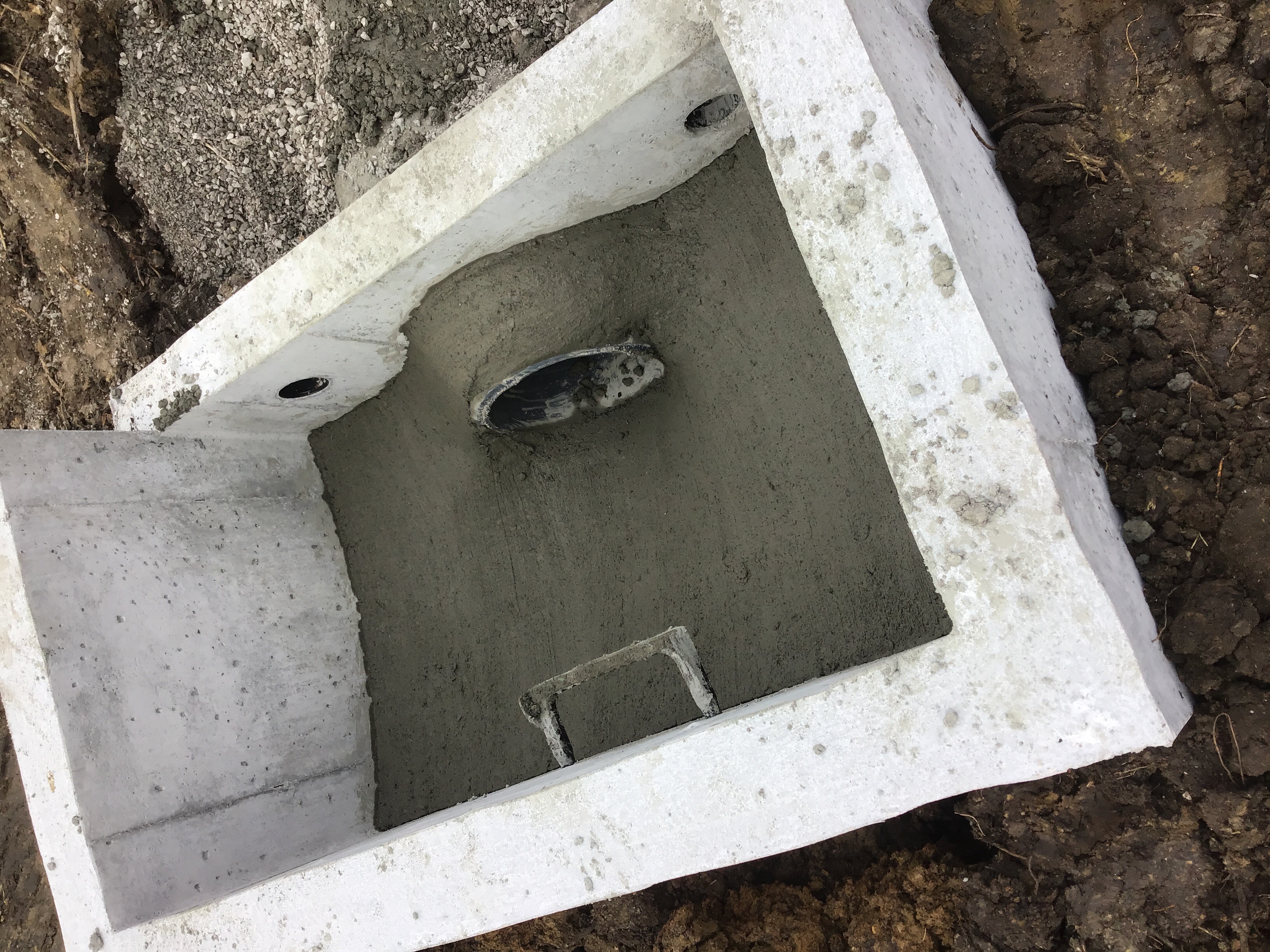

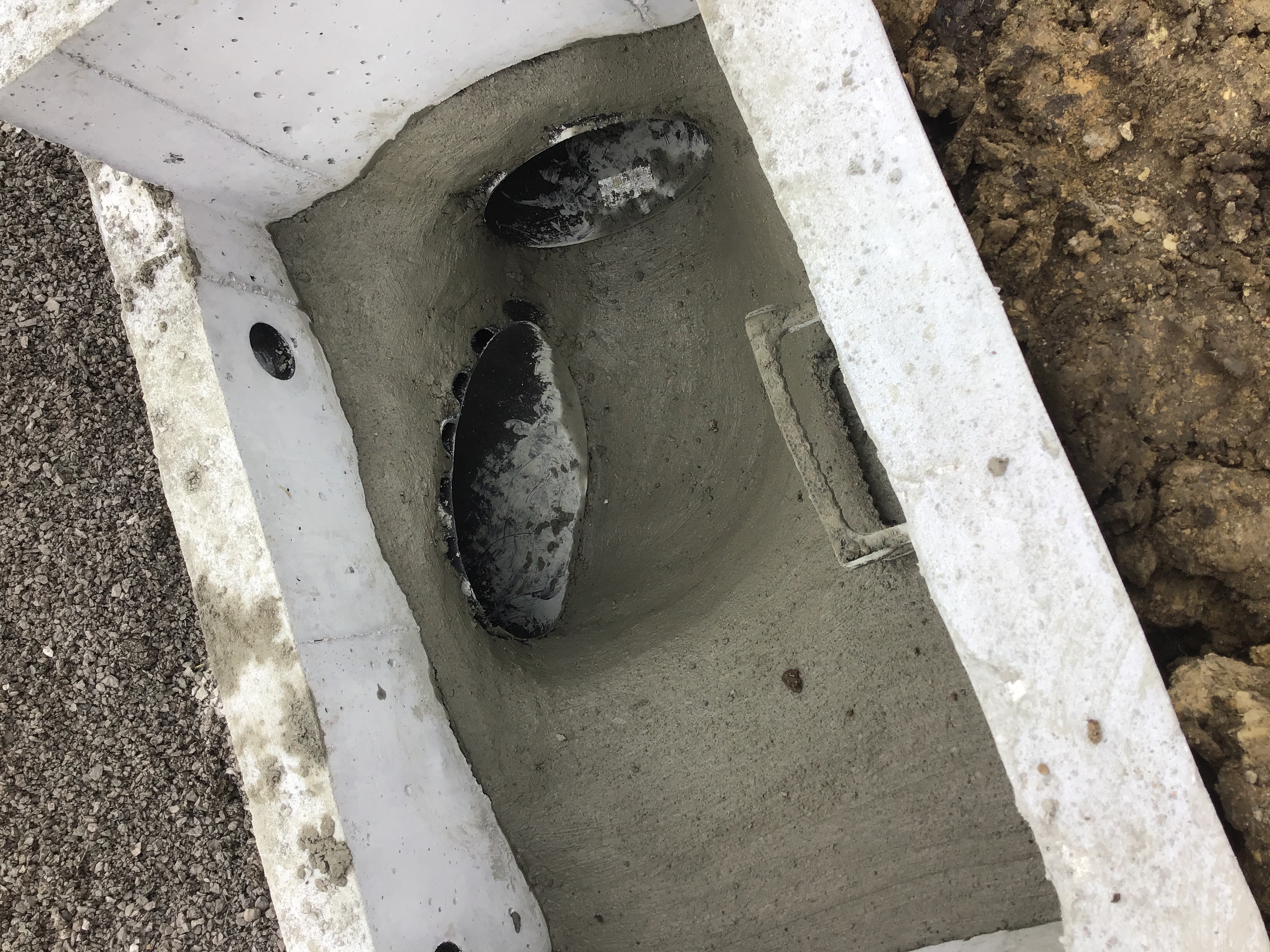

09/05/2019 Storm inlet
09/05/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter INSPECTION SUMMARY
03/17/2020 Letter INSPECTION SUMMARY
03/17/2020 20
03/17/2020 21

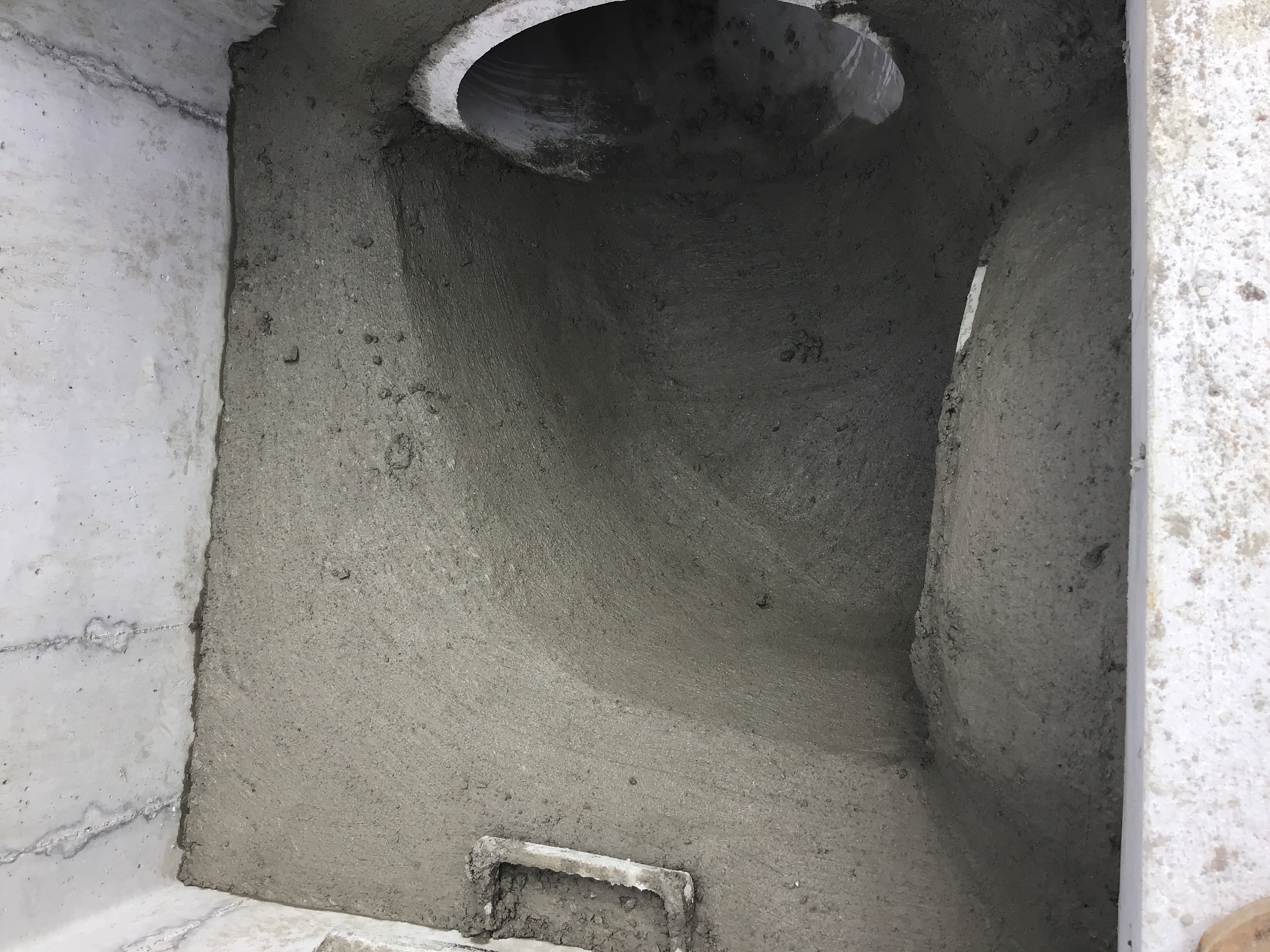

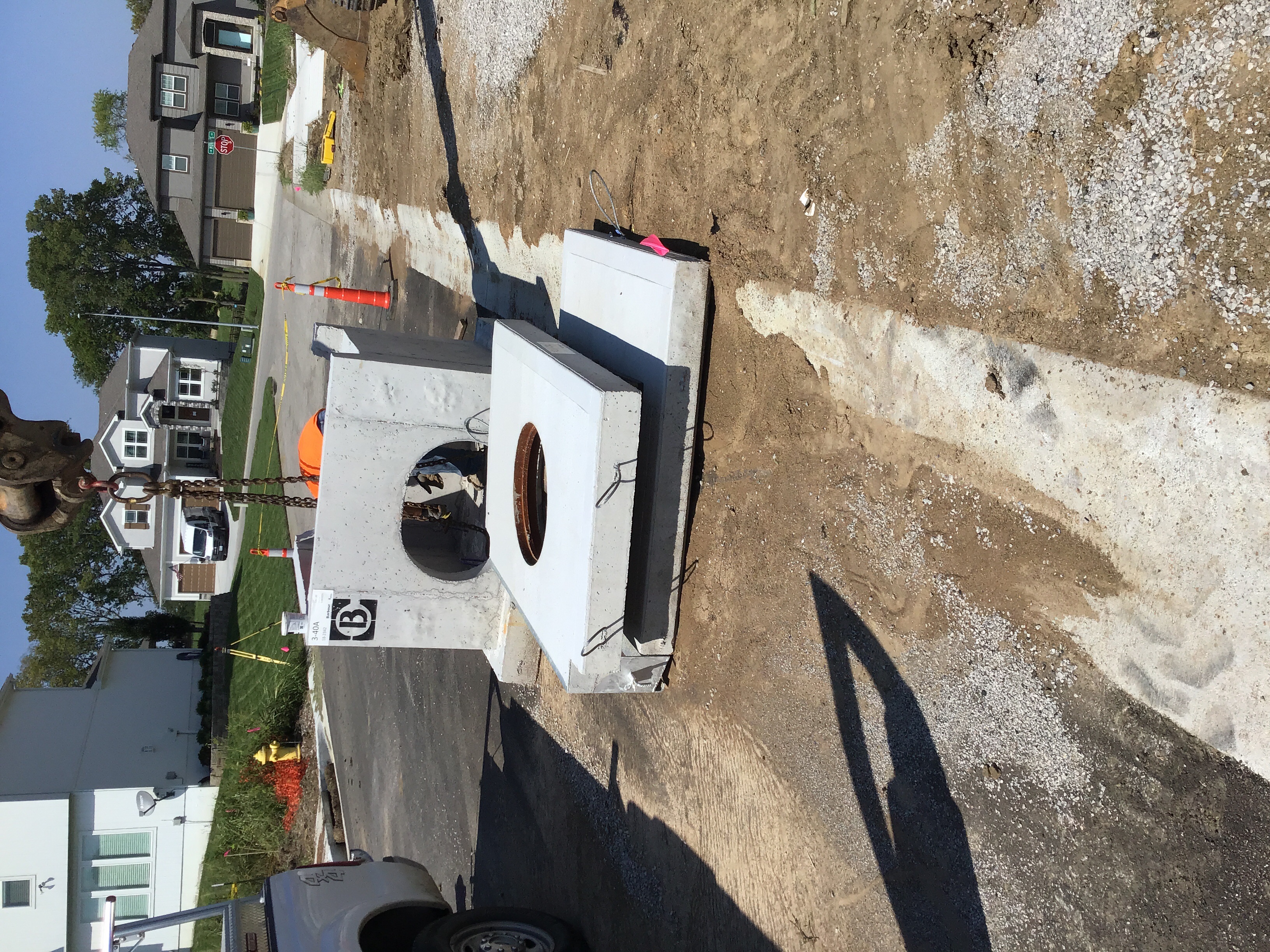

09/06/2019 Storm revised field inlet
09/06/2019 Letter INSPECTION SUMMARY
09/09/2019 Letter INSPECTION SUMMARY
09/09/2019 Letter INSPECTION SUMMARY
09/13/2019 Letter INSPECTION SUMMARY
09/20/2019 Letter INSPECTION SUMMARY
07/27/2023 Letter DE-Certificate of Final Acceptance (Commercial)
09/16/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/18/2019 Letter INSPECTION SUMMARY
09/20/2019 Letter INSPECTION SUMMARY
09/26/2019 WO#1I91244 - City of Lees Summit
09/26/2019 WO#1I91136 - City of Lees Summit
12/10/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
12/10/2019 Letter DE-Punch List

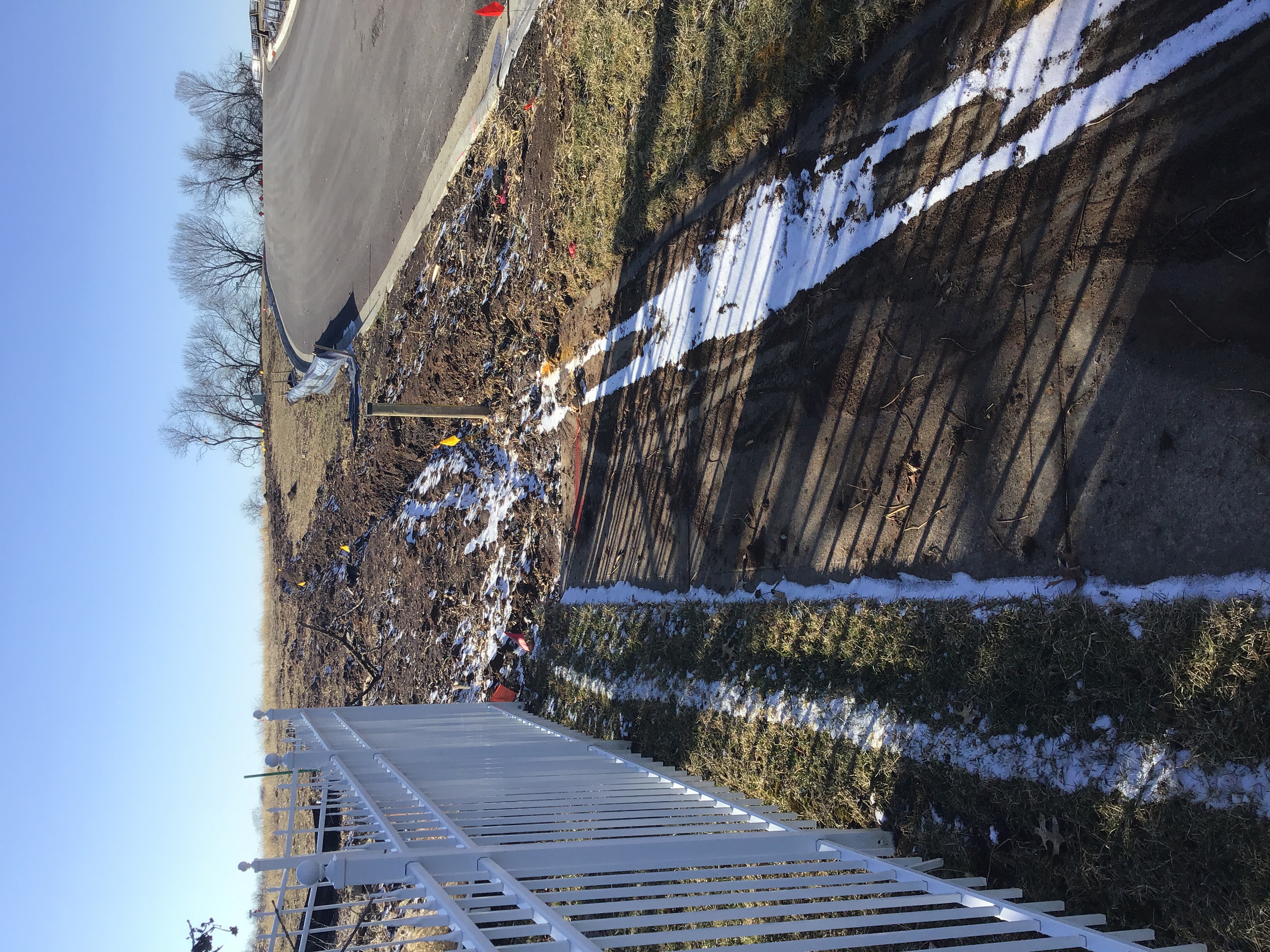

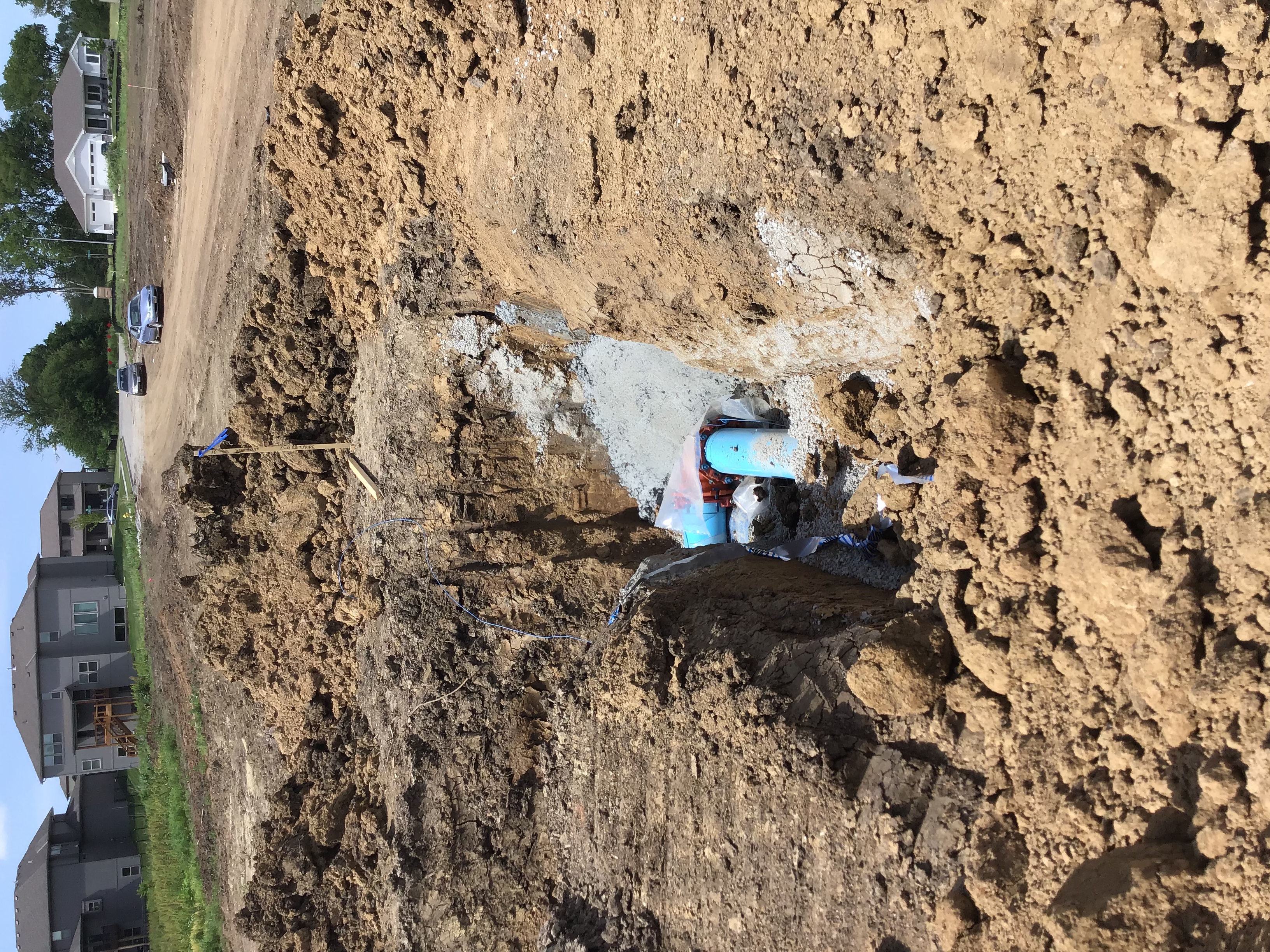

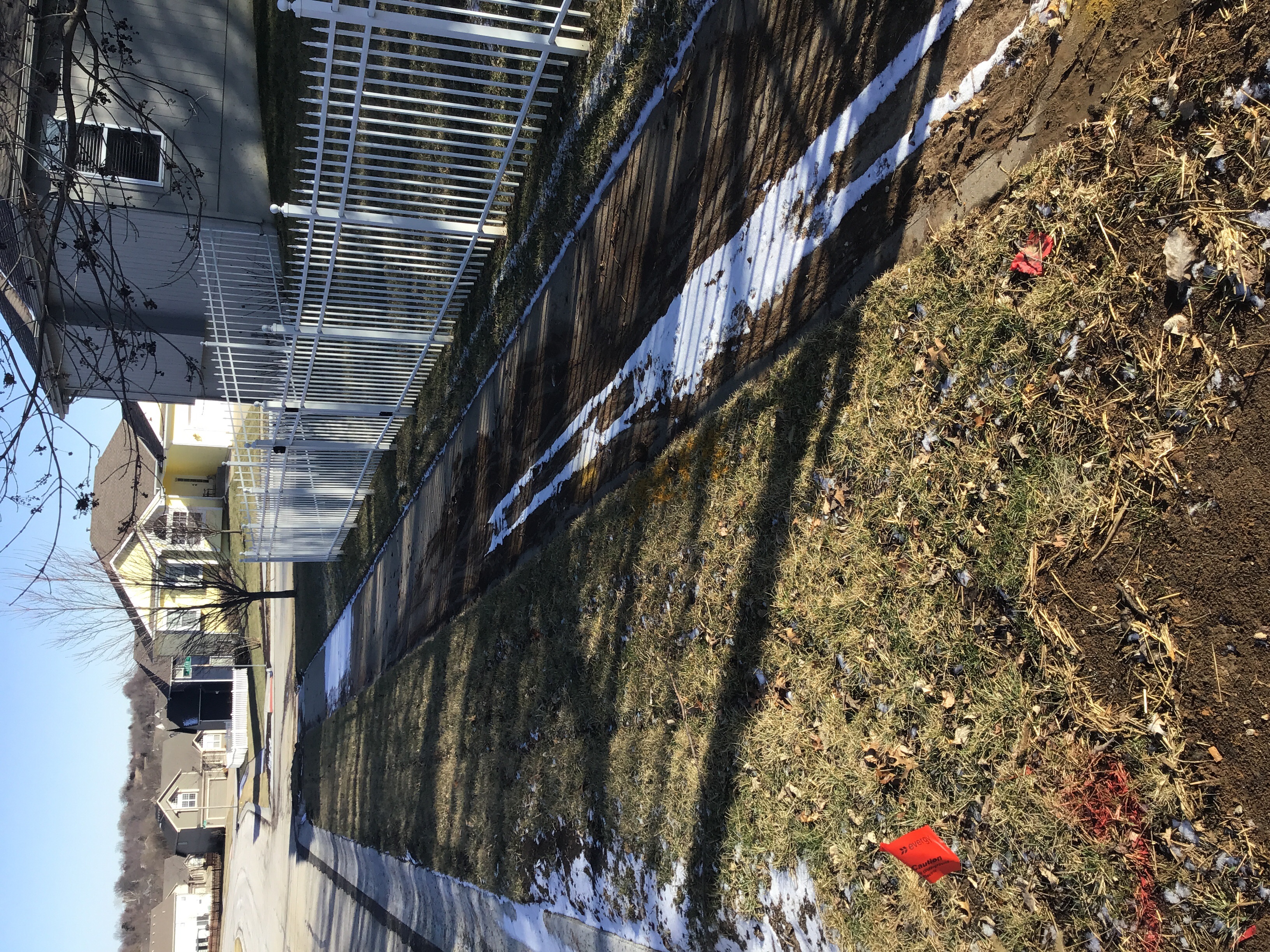

02/06/2020 Failed Erosion Control SW KLINE AVE
02/06/2020 Failed Erosion Control SW KLINE AVE0
02/06/2020 Letter INSPECTION SUMMARY
03/06/2020 Summit View Farms 3rd Plat Signed Certificate of Substantial Completion
03/06/2020 Summit View Farms 3rd Plat Signed Punch List
03/06/2020 Summit View Farms 3rd Plat Signed Certificate of Substantial Completion
03/06/2020 Summit View Farms 3rd Plat Signed Punch List
03/19/2020 Letter INSPECTION SUMMARY
03/02/2020 Final Affidavit & Agreement
03/02/2020 Maint Bond - SVF 3rd
03/02/2020 Authorization to Date bond
07/29/2020 Letter INSPECTION SUMMARY
07/29/2020 Letter INSPECTION SUMMARY
07/23/2020 Letter DE-Daily Inspection Summary
08/10/2020 Letter INSPECTION SUMMARY
07/30/2020 Letter INSPECTION SUMMARY
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
