Permit Application Status

PRSUBD20181667

In order to schedule inspections, you need to be signed in.

 /

Note: You can collapse and expand individual sections by clicking the header of the section you wish to collapse/expand.

Summary

PRSUBD20181667
Public Infrastructure
Final Acceptance
WHISPERING WOODS LAND LLC
DEVELOPMENT COMPLETE
Whispering Woods 1st Plat - Full infrustructure improvements
05/31/2018
07/26/2018
12/16/2022
08/04/2023
Locations
Address
1928 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1924 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1920 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1916 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1912 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1908 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1904 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1909 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1905 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1828 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1824 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1820 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1816 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1812 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1808 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1804 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1800 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1724 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1717 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1721 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1801 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1805 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1713 SW 26TH TER, LEES SUMMIT, MO 64082

Address
1717 SW 26TH TER, LEES SUMMIT, MO 64082

Address
1716 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1712 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1708 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1709 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1713 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1717 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1721 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1725 SW 27TH ST, LEES SUMMIT, MO 64082

Address
1900 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1902 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Address
1901 SW RIVER RUN DR, LEES SUMMIT, MO 64082

Property
69130081800000000

Property
69130061900000000

Property
69130061800000000

Property
69130061700000000

Property
69130062000000000

Property
69130081700000000

Property
69130062100000000

Property
69130062200000000

Property
69130061500000000

Property
69130081600000000

Property
69130062300000000

Property
69130062400000000

Property
69130071600000000

Property
69130071500000000

Property
69130071400000000

Property
69130071300000000

Property
69130062500000000

Property
69130062600000000

Property
69130071100000000

Property
69130062700000000

Property
69130062800000000

Property
69130041600000000

Property
69130062900000000

Property
69130041500000000

Property
69130060100000000

Property
69130041400000000

Property
69130060200000000

Property
69130041300000000

Property
69130052000000000

Property
69130071200000000

Property
69130081000000000

Property
69130081100000000

Property
69130081200000000

Property
69130081300000000

Property
69130081400000000

Property
69130061600000000

Address
1704 SW 27TH ST, LEES SUMMIT, MO 64082

Contacts
WHISPERING WOODS LAND LLC, Address:803 PCA ROAD
REDFORD CONSTRUCTION INC, Address:PO BOX 1065, Phone:(816) 540-2030
WAKEMAN SHAWN P & TONI R, Address:1708 SW 27TH ST
DAWN ROCHELLE O'GUIN REVOCABLE TRUST DATED 03/10/2014, Address:1704 SW 27TH ST
DICIOCCIO RYAN J & ANGELA, Address:1712 SW 27TH ST
ROBINSON GERALD C, Address:1716 SW 27TH ST
BERNIE F MCARDLE & SHANNON M MCARDLE, Address:1709 SW 27TH ST
SORENSEN BRETT & TESS, Address:1713 SW 27TH ST
WARDEN DWAYNE & MEGAN, Address:1717 SW 27TH ST
MARZULLO JOSEPH III & PAULA, Address:1721 SW 27TH ST
CHAMBLISS-WILLIAMS PAMELA JEANETTE & WILLIAMS RICKY K, Address:1725 SW 27TH ST
SPURLIN SHANNON R & SCOTTIE L, Address:1713 SW 26TH TER
HILL JEFFREY J & AMANDA J, Address:1717 SW 26TH TER
GREENO ADAM P & LINDSEY B, Address:1717 SW RIVER RUN DR
YOUNG LOUIS J & JULIE B, Address:1721 SW RIVER RUN DR
POTTS PRENTES & CODI, Address:1801 SW RIVER RUN DR
YATES AARON D & LEHMAN KRISTEN, Address:1805 SW RIVER RUN DR
SELL BRIAN THOMAS & MELANIE ANN, Address:1905 SW RIVER RUN DR
BURNETT CHARLES V, Address:1909 SW RIVER RUN DR
SEALER JOEL P & KRISTI, Address:1800 SW RIVER RUN DR
BARRETT MARK A, Address:1804 SW RIVER RUN DR
WOLLERMAN TRUST DATED FEBRUARY 2, 2024, Address:1808 SW RIVER RUN DR
SIVULKA CHRISTINE & MICHAEL, Address:1812 SW RIVER RUN DR
KURTH CHERYL LYNN & LYLE EUGENE, Address:1816 SW RIVER RUN DR
YUHAS REVOCABLE TRUST DATED 03-11-2016, Address:1820 SW RIVER RUN DR
STRETZ SCOTT & JANET, Address:1824 SW RIVER RUN DR
JAHAN AZMI & SHUARA SAODA, Address:1828 SW RIVER RUN DR
GARTON REBECCA, Address:1904 SW RIVER RUN DR
RAY MICHAEL K & LESLIE D, Address:1908 SW RIVER RUN DR
BAUMGARTEN RICKY & DANA LEE, Address:1912 SW RIVER RUN DR
PRESTON BRANDON & KIMBERLY, Address:1916 SW RIVER RUN DR
PADDOCK RODNEY, Address:1920 SW RIVER RUN DR
BYERS STEPHANIE LORAINE, Address:1924 SW RIVER RUN DR
ROSS CONSUELO, Address:1928 SW RIVER RUN DR
Reviews
Review Type Outcome Est. Completion Date Completed
Licensed Contractors Approved 05/31/2018 07/25/2018
Tom Chandler
Fees
Paid Fees Amount Paid Owing Date Paid
91100C8-Sanitary Sewer Insp Fees $8,233.65 $8,233.65 Paid 07/23/2018
9110081-Paved Surface Inspection Fee $14,110.32 $14,110.32 Paid 10/04/2018
91100C8-Sanitary Sewer Insp Fees $90.00 $90.00 Paid 10/04/2018
$8,323.65
9110071-Site Grading Fee $2,042.05 $2,042.05 Paid 10/04/2018
9110068-Storm Fee $7,290.33 $7,290.33 Paid 10/04/2018
9110072-Water Test Fee $1,000.00 $1,000.00 Paid 03/29/2019
91100C9-Water Insp Fee $8,234.64 $8,234.64 Paid 03/29/2019
Outstanding Fees Amount Paid Owing Date Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $150.00 $0.00 $150.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $200.00 $0.00 $200.00 Not Paid
9110069-After Hours Inspections (Public Works)(Per Hour) $200.00 $0.00 $200.00 Not Paid

$550.00    Add Fees to My Cart
Inspections
Inspection Outcome Requested Scheduled Date Inspected
Erosion Control Inspection Passed 7/26/2018 07/26/2018
Informational
07/26/2018

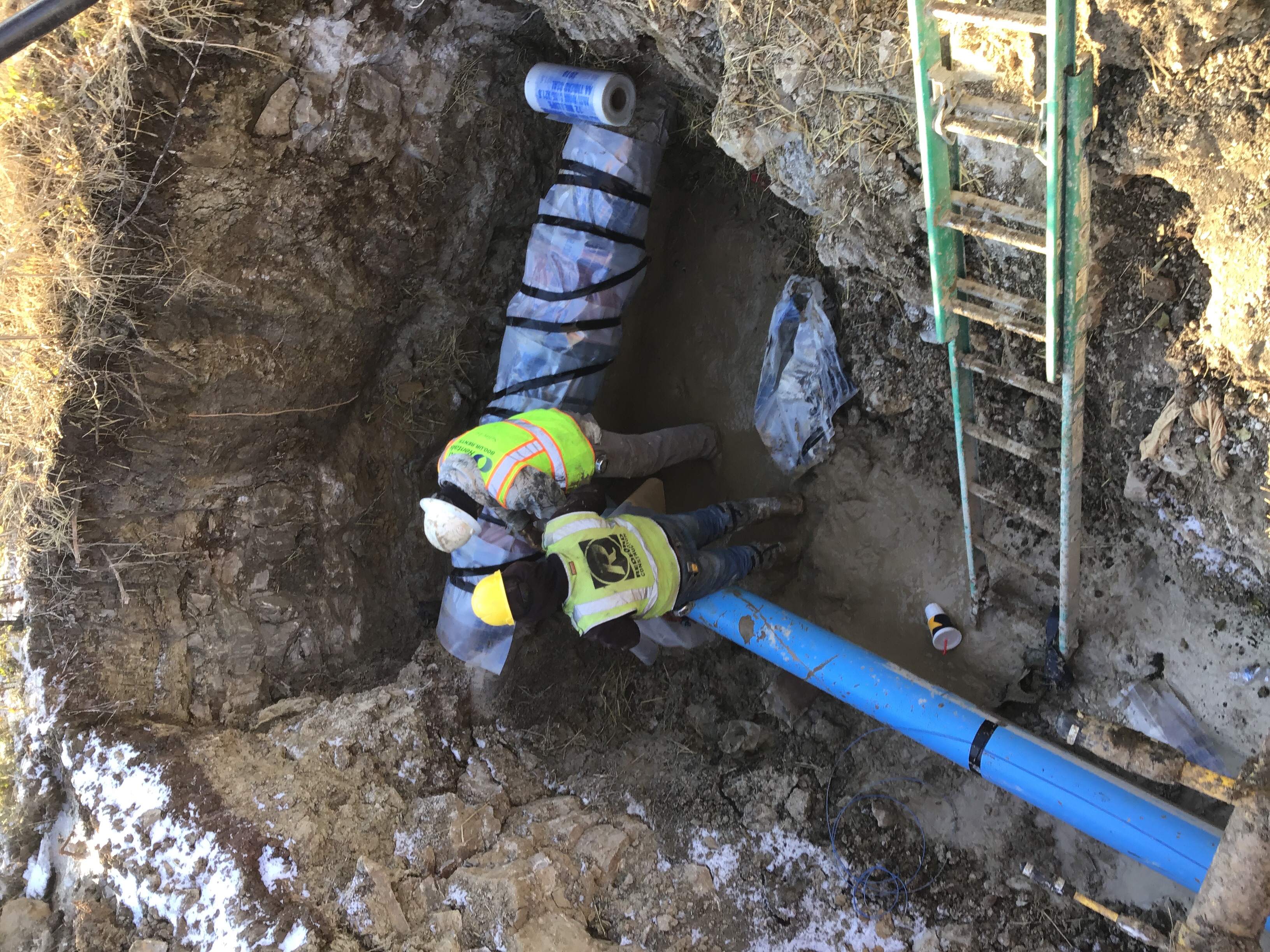

Tom Chandler 07/26/2018 12:36 PM Installed prior with land disturbance permit. Will monitor throughout construction.
Sanitary Sewer Construction Inspection Partial 7/26/2018 at 7:30 AM 07/26/2018
Informational
07/26/2018
Tom Chandler 07/26/2018 12:38 PM Beginning construction at existing MH 51-003. Cored into manhole and began installing 8" SDR 26 sanitary sewer line A. Installed 42L/F and plugged for the day. Rain came and contractor done for the day.
Sanitary Sewer Construction Inspection Partial 7/31/2018 08/01/2018
Informational
08/01/2018
Tom Chandler 08/01/2018 1:32 PM Installed the remaing sewer line A. Installed MH A-2 and MH A-3. Installed service laterals,tracer wire, and trench checks for lots 6-9. Installed marker tape and backfilled.
Sanitary Sewer Construction Inspection Partial 8/6/2018 08/07/2018
Informational
08/07/2018
Tom Chandler 08/07/2018 10:23 AM Begin working on Sanitary sewer main line H. Installed up to station 2+00 and service wye for lot 1. Installed MH H-1. Installed back inside MH H-1 to keep school in service until line H is completed and tested.
Sanitary Sewer Construction Inspection Partial 8/8/2018 08/09/2018
Informational
08/09/2018
Installed sanitary main line H up to station 3+00. Installed service wyes for lots 2 and 3 as well. Talked to Kent Monter about service laterals for lots 1-5. Plans have laterals extended just past back of curbs. Laterals will be extended to the utility easement.
Sanitary Sewer Construction Inspection Partial 8/9/2018 08/09/2018
Informational
08/09/2018
Installed sanitary sewer main line H up to station 3+64. Installed MH H-2. Installed service wyes for lots 4 and 5. Working on service laterals this afternoon.
Sanitary Sewer Construction Inspection Partial 8/10/2018 08/13/2018
PW-Main inspection
Informational
08/13/2018
Ron Paynter, Joe Starlin and I made two site visits AM & PM to inspect the sanitary line A. The Redford crew had 6 of the lateral's installed and the MH A-2 installed. They poured the trench checks for the service line with flowable fill. We verified the size and locations of the trench checks.
Sanitary Sewer Construction Inspection Partial 8/16/2018 08/16/2018
Informational
08/16/2018
Tom Chandler 08/16/2018 4:28 PM Contractor on-site today to backfill Line H. KCTE lab on-site for testing of the backfill. Sanitary sewer line H is in the roadway.
Sanitary Sewer Construction Inspection Partial 8/27/2018 at 8:45 AM 08/27/2018
Informational
08/27/2018
Tom Chandler 08/27/2018 10:21 AM Contractor removing and replacing MH G-1. Will begin installing sanitary sewer line G.
Sanitary Sewer Construction Inspection Partial 8/29/2018 08/30/2018
Informational
08/30/2018
Tom Chandler 08/30/2018 2:17 PM Removed and replaced existing MH G-1. Installed 126 L/F of 24" SDR 26 pipe. Poured invert and existing main back in service.
Sanitary Sewer Construction Inspection Partial 9/5/2018 09/05/2018
Informational
09/05/2018
Tom Chandler 09/05/2018 1:43 PM Contractor worked yesterday and this morning until 11:00AM on sanitary sewer main line G. Rained out this afternnon. Installed up to MH G-3. Did not install manhole.Trench was backfilled and end of line was plugged.
Sanitary Sewer Construction Inspection Partial 9/10/2018 09/11/2018
Informational
09/11/2018
Tom Chandler 09/11/2018 11:28 AM Worked on sanitary sewer line G yesterday. Installed MH G-3 as well. Engineers looking into problems with construction of MH G-4 base. Waiting for resolution today. Contractor continuing to install 24" SDR 26 for line G.
Sanitary Sewer Construction Inspection Partial 9/19/2018 09/19/2018
Informational
09/19/2018
Tom Chandler 09/19/2018 2:44 PM Contractors have installed sanitary sewer main line B. Installed all manholes except for MH B-4. Installed service wyes and laterals for lots 25 thru 33, future lots 121-122, future lots 134-135 and lot 11. Installed anode, tracer wire and trench checks as well. Backfilled and tested moisture,density in road crossing as well. Installed sanitary sewer main line C up to MH C-2/D-1. Installed service wyes and laterals for lots 12-15 as well. Installed anodes,tracer wire and trench checks.
Sanitary Sewer Construction Inspection Partial 9/21/2018 09/21/2018
Informational
09/21/2018
Tom Chandler 09/21/2018 3:54 PM Installed MH G-4/E-1 and installing outside drop as well. Poured concrete for outside drops at MH B-1 and C-1 as well.
Sanitary Sewer Construction Inspection Partial 9/25/2018 09/25/2018
Informational
09/25/2018
Tom Chandler 09/25/2018 2:34 PM Contactor working on sanitary sewer main line E.
Sanitary Sewer Construction Inspection Partial 10/2/2018 10/02/2018
Informational
10/02/2018
Tom Chandler 10/02/2018 3:19 PM Contractor working on line E and should finish tomorrow. Will pour trench checks and inverts. Will backfill and KCTE will be on-site for testing of backfill.
Sanitary Sewer Construction Inspection Partial 10/4/2018 10/04/2018
Informational
10/04/2018
Tom Chandler 10/04/2018 3:18 PM Contractor has completed Line D and Line E. All the sanitary has been completed and backfilled.

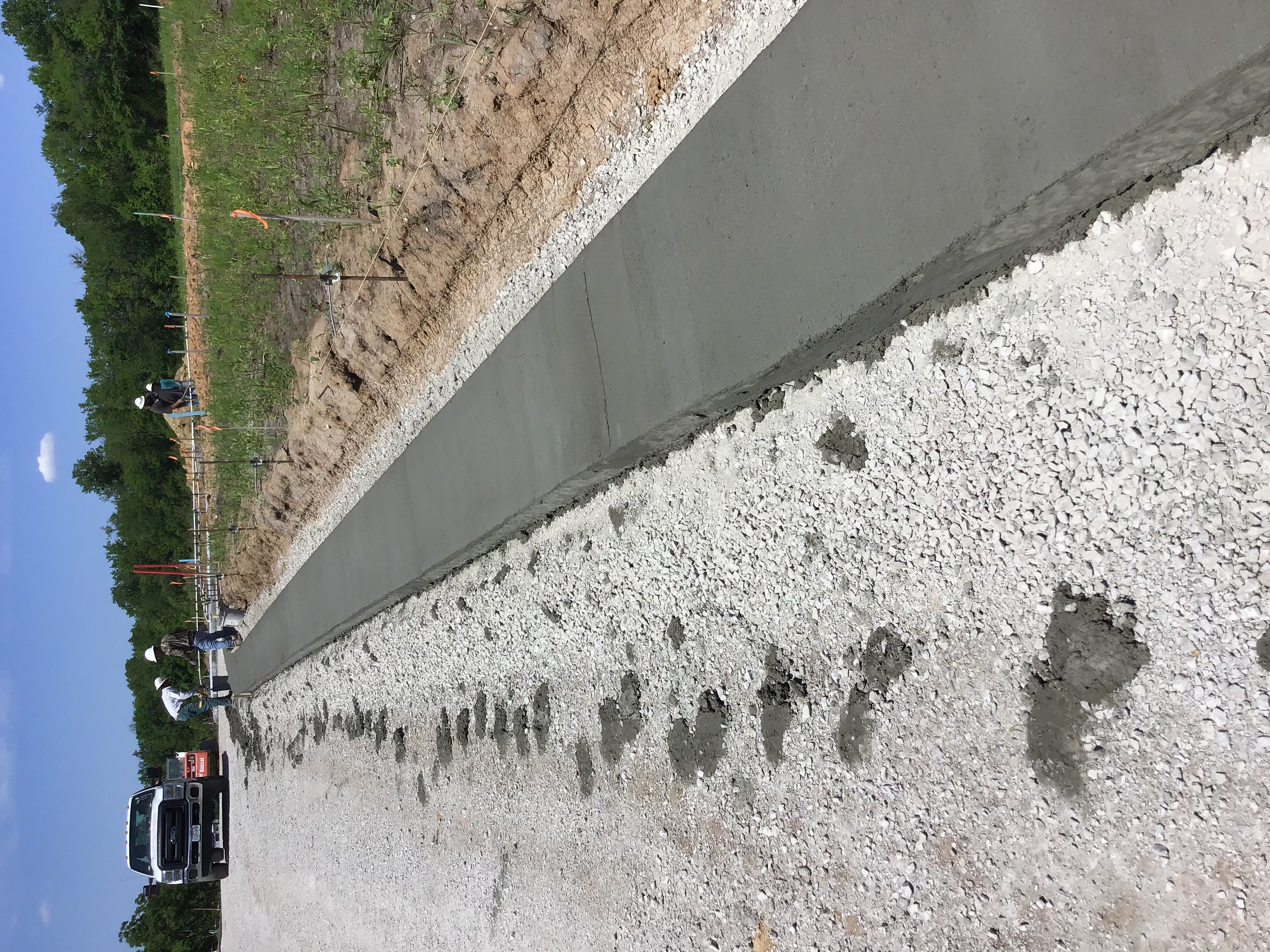

Storm Sewer Construction Inspection Partial 10/16/2018 10/17/2018
Informational
10/17/2018
Tom Chandler 10/17/2018 7:03 AM Contractor began storm sewer construction. Delivered approved plans on 8/11/2018.
Storm Sewer Construction Inspection Partial 10/17/2018 at 3:00 PM 10/17/2018
Informational
10/17/2018
Tom Chandler 10/17/2018 3:59 PM Installed storm sewer line C. Installed FES C-1,JB C-2,CI C-3 and CI C-4.
Storm Sewer Construction Inspection Partial 10/18/2018 10/19/2018
Corrective Action Required
10/19/2018
Tom Chandler 10/19/2018 12:53 PM Installed up to station 6+30. Installed all structure up to CI C-6.Contractor installed 36" RCP between CI C-3 and CI C-4. Plans called for 42" RCP. Will need to reinstall or be granted approval/wainver to leave installed.
Storm Sewer Construction Inspection Partial 10/30/2018 10/30/2018
Misc
Informational
10/30/2018
Installed storm sewer line G up to storm box G-4.
Storm Sewer Construction Inspection Partial 10/31/2018 10/31/2018
Misc
Informational
10/30/2018
Installed storm sewer line G up to storm box G-4. Install 120 feet of HDPE storm sewer pipe.
Storm Sewer Construction Inspection Partial 11/1/2018 11/01/2018
Misc
Informational
10/31/2018
Installed storm sewer line G up to storm box G-4. Install 120 feet of HDPE storm sewer pipe.
Storm Sewer Construction Inspection Partial 11/8/2018 11/08/2018
Misc
Informational
11/01/2018
Installed storm sewer line G up to storm box G-4. Install 120 feet of HDPE storm sewer pipe.
Informational
11/08/2018
Tom Chandler 11/08/2018 2:29 PM Installing storm sewer line A1. Installed ES A1-1 and 18" RCP.
Sanitary Sewer - Vacuum Partial 11/27/2018 at 11:15 AM 11/27/2018
Informational
11/27/2018
John DiMauro 11/27/2018 11:35 AM The crew vacuum tested MH E-1 The gauge dropped from 10 to 9.5 during the 2.5 min test. Test Passed. Vacuum test for MH G-3 The gauge dropped below the allowed limit in the 2.5 minute test. Test Failed
Sanitary Sewer - Air Test Partial 11/27/2018 at 8:45 AM 11/27/2018
Informational
11/27/2018
John DiMauro 11/27/2018 10:39 AM Air pressure test for the sanitary sewer line G. The test for the Line segment from station 6+27.21 to 7+77.05 is 149.84 LF. Start PSI: 4 End PSI: 4 Test Time: 34 min 10 sec Test passed The test for the Line segment from station 2+27.21 to 6+27.21 is 400 LF. Start PSI: 4 End PSI: 4 Test Time: 91 min 12 sec Test passed
Sanitary Sewer - Air Test Partial 11/28/2018 at 8:00 AM 11/28/2018
Misc
Informational
11/28/2018
John DiMauro 11/28/2018 9:11 AM Air pressure test for the sanitary sewer line G. The test for the Line segment from station 0+00 to 2+27.21 is 227.21 LF. Start PSI: 4 End PSI: 4 Test Time: 51 min 42 sec Test passed
Sanitary Sewer - Vacuum Partial 11/28/2018 at 9:15 AM 11/28/2018
Misc
Informational
11/28/2018
John DiMauro 11/28/2018 10:08 AM The crew vacuum tested MH B-1 The gauge held at 10 with no drop during the 2.5 min test. Test Passed.
Erosion Control Inspection Partial 4/9/2019 at 2:30 PM 04/09/2019
Misc
Corrective Action Required
04/09/2019
John DiMauro 04/09/2019 3:40 PM I met with David Parks on site to discuss the erosion control issues. I am going to meet with him and his Erosion control contractor on site tomorrow morning to go the corrections needed.

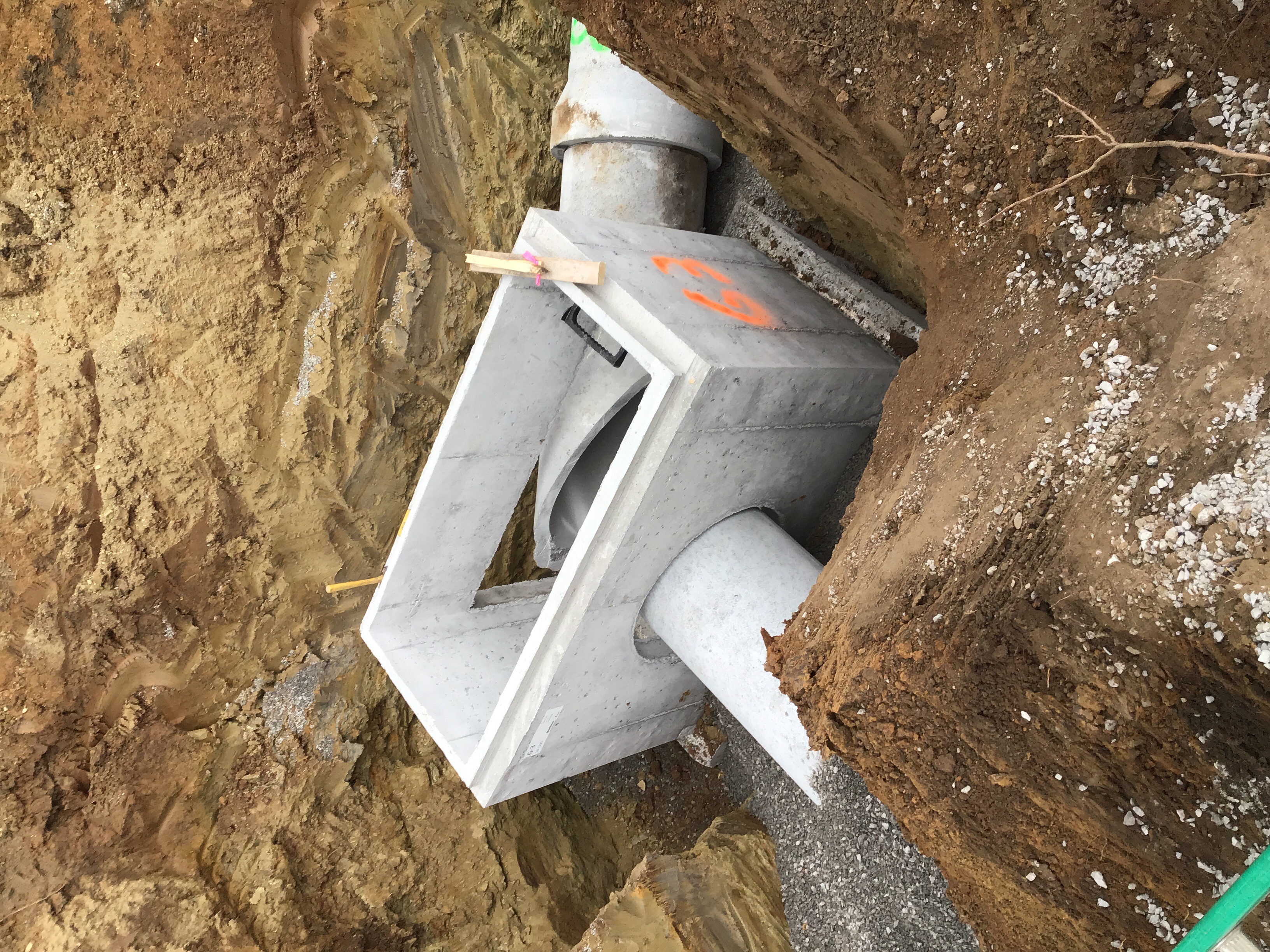

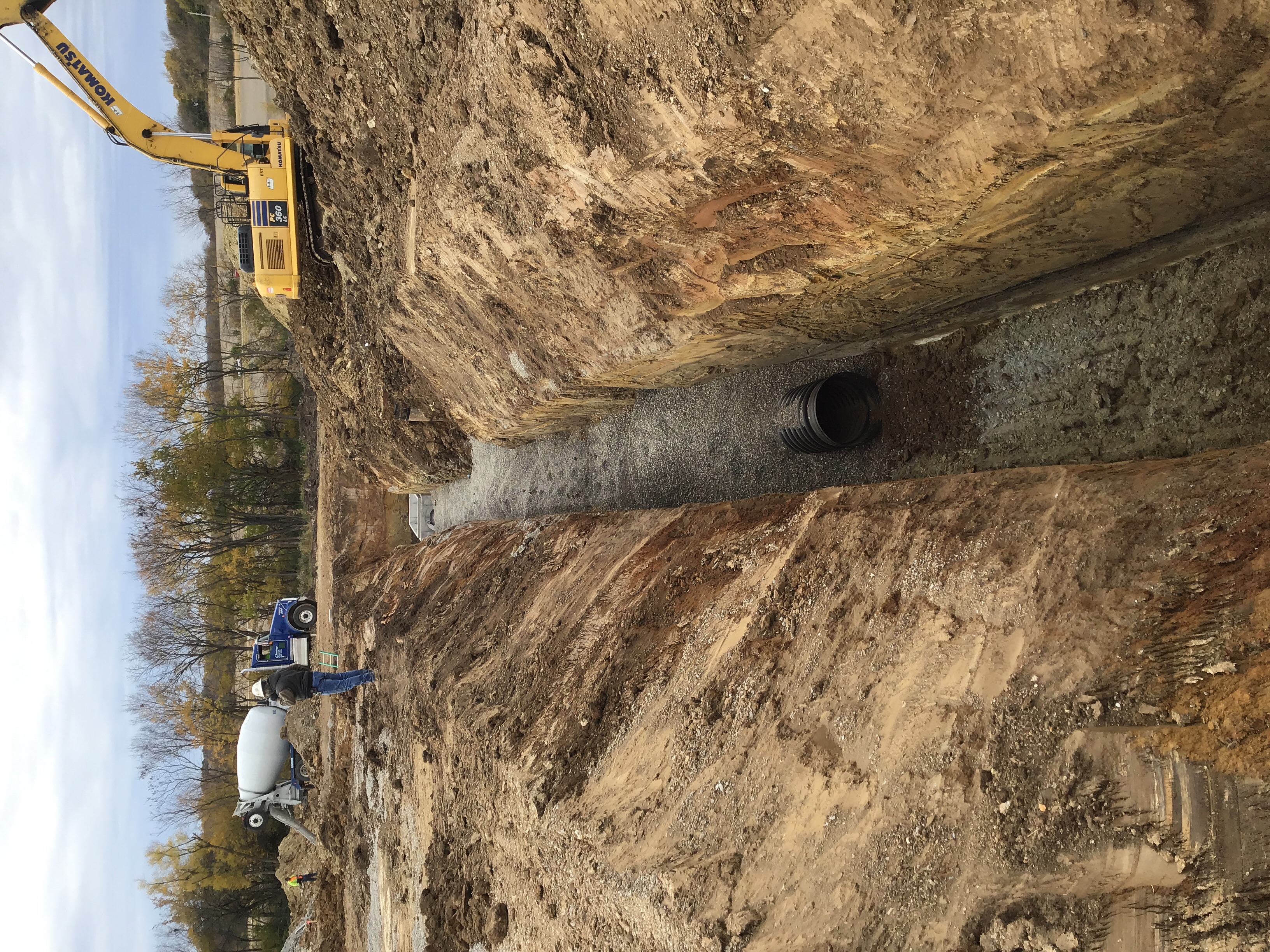

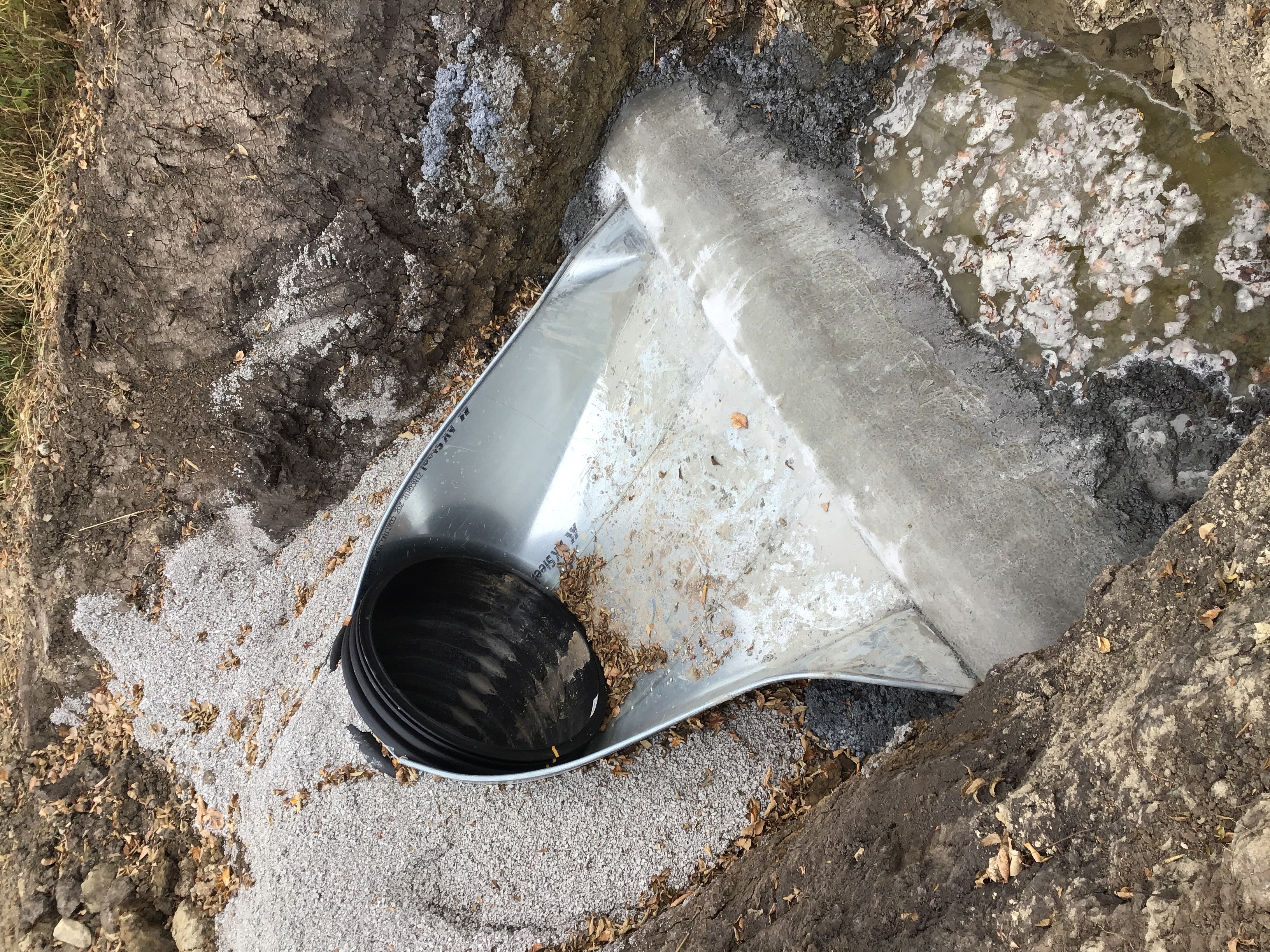

Sanitary Sewer Construction Inspection Passed 04/10/2019
Misc
Informational
04/10/2019

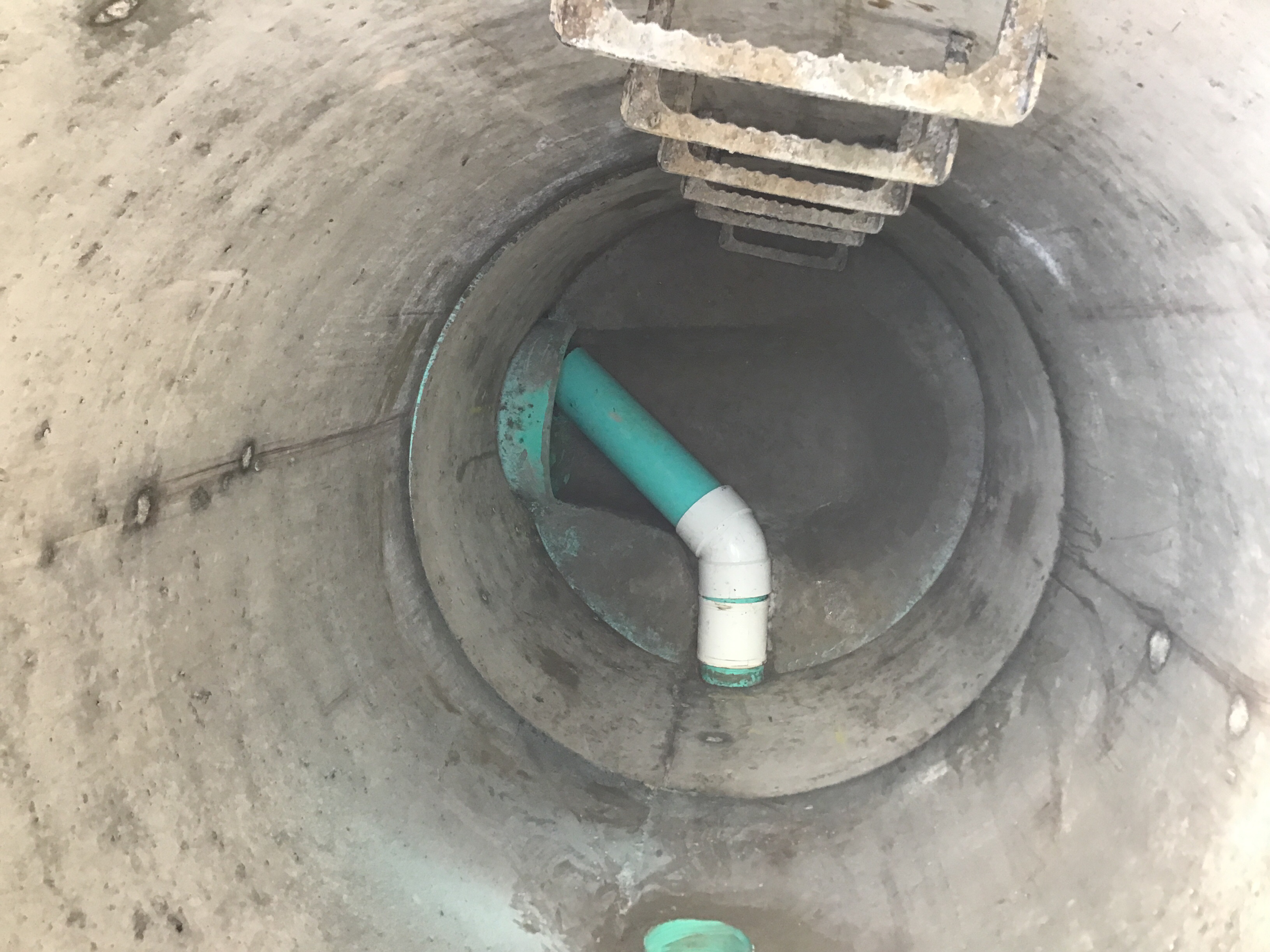

The Redford crew installed the sanitary service lateral on the existing 15” main for lot 10. Photos are attached.
Detention Basin Partial 4/11/2019 at 9:30 AM 04/11/2019
Misc
Informational
04/11/2019

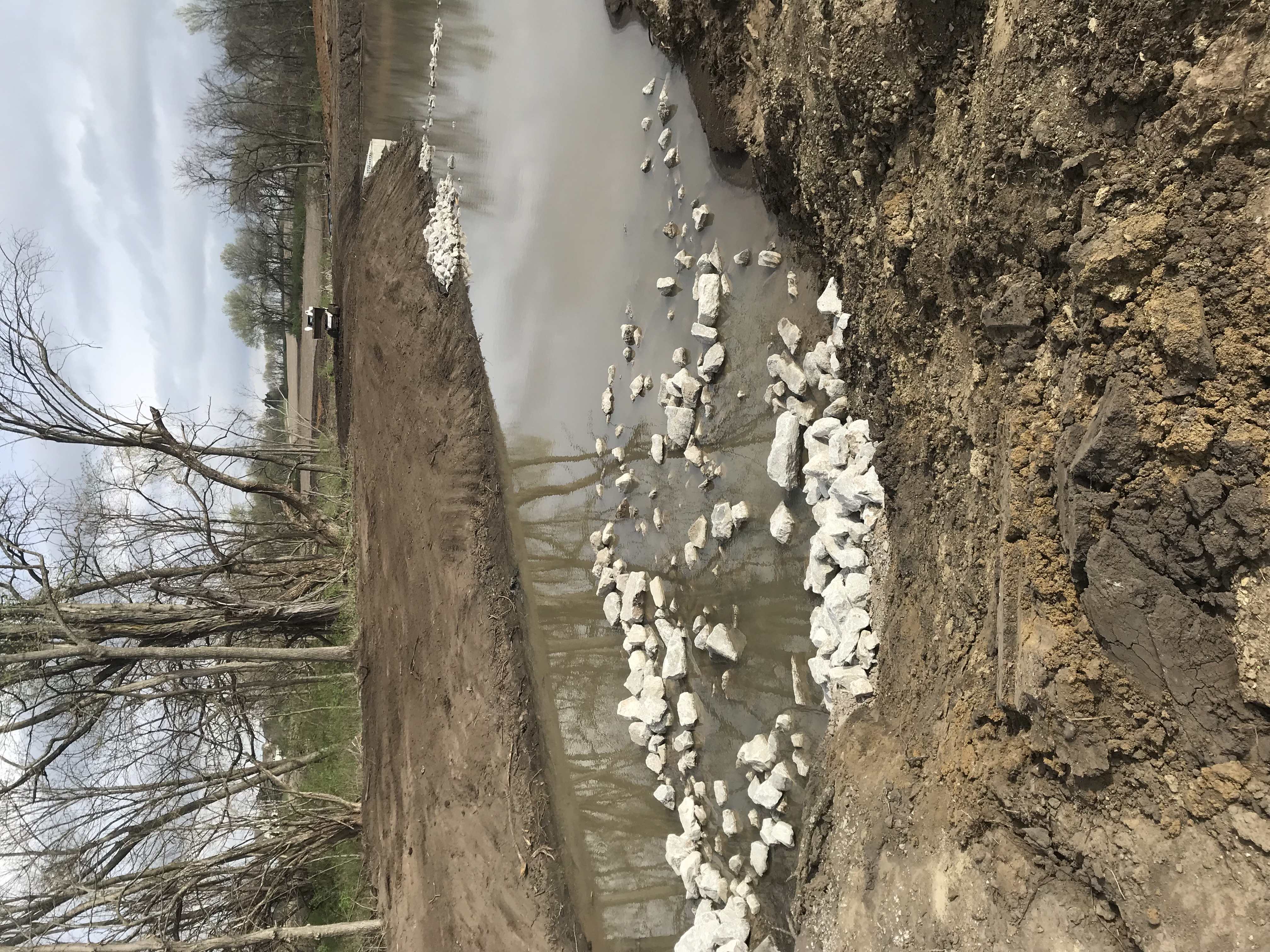

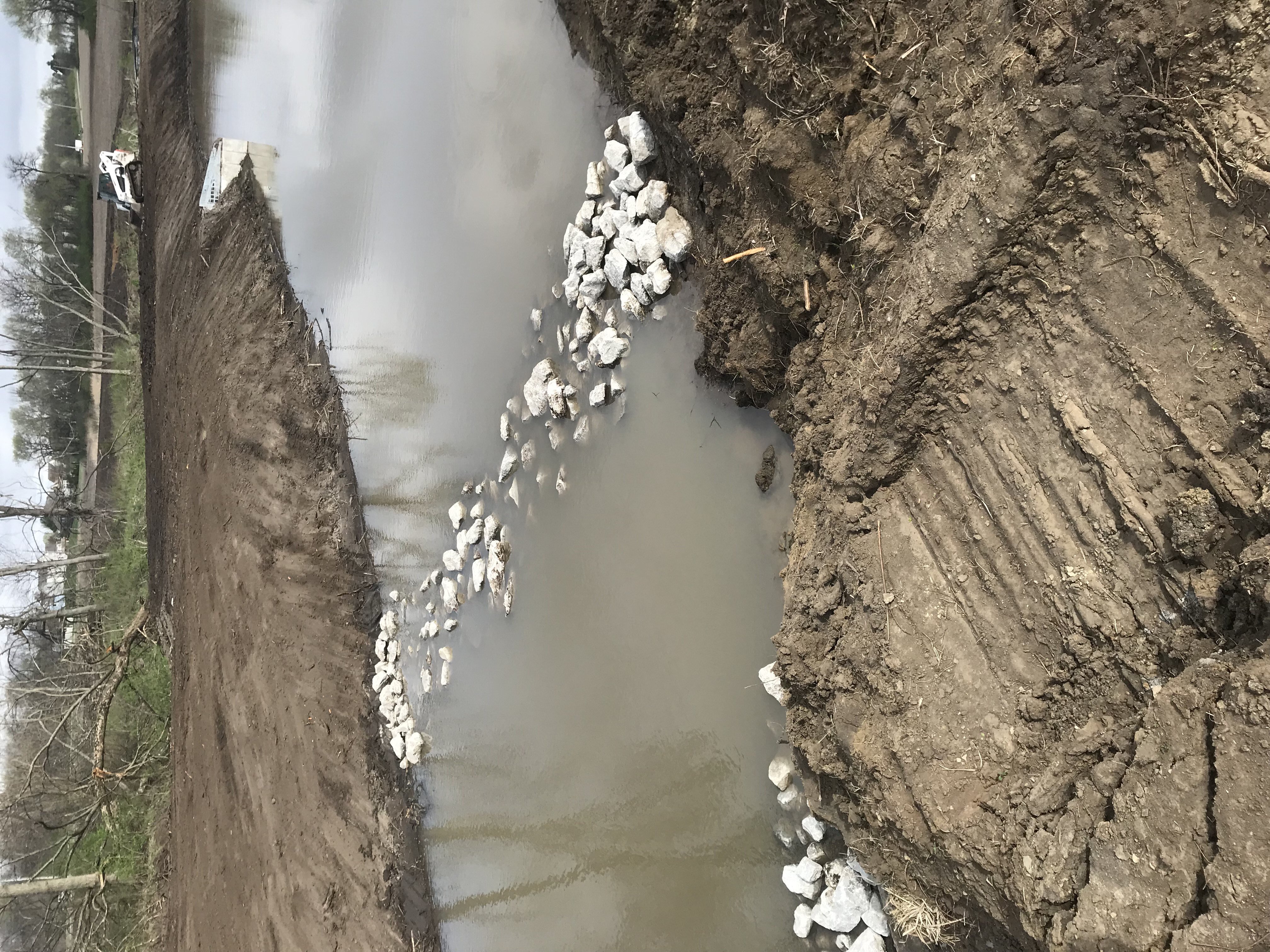

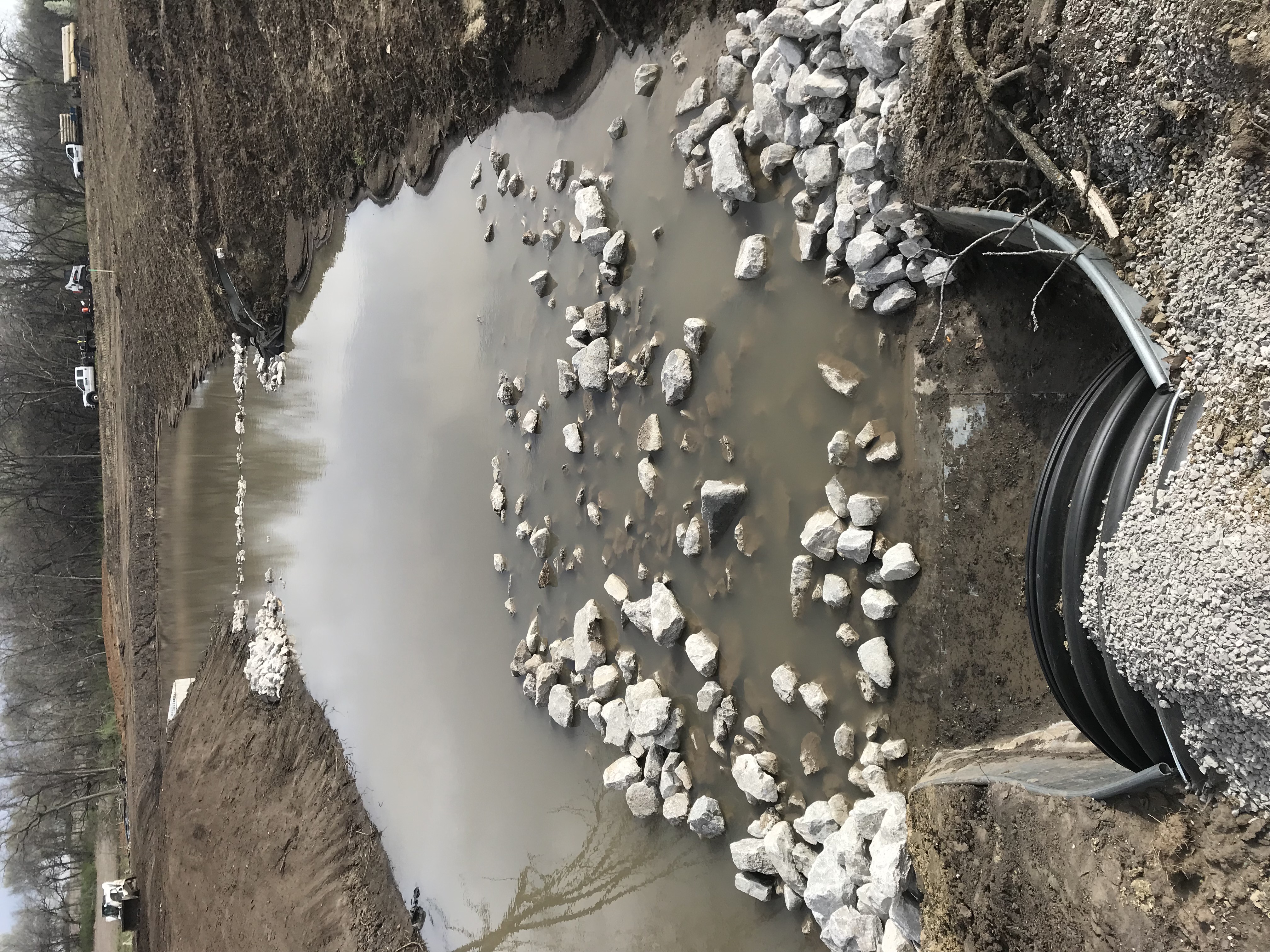

John DiMauro 04/11/2019 10:29 AM The Redford crew installed the riprap for the basin. The size, location and depth of the rip rap appears to match the approved plans. Photos are attached.
Storm Sewer Construction Inspection Partial 4/11/2019 at 9:45 AM 04/11/2019
Misc
Informational
04/11/2019

John DiMauro 04/11/2019 3:58 PM The RedFord crew made the corrections to the curb inlets B-1 & B-2. They installed the new curb inlet box B-2 and ran the 34'ft of 18"RCP pipe between the boxes under the road. The collars for hte boxes are poured but they still need to pour the inverts. The crew also patched the 30" hole in the box culvert per the revised plan sheet # 26. *I did not inspect the hole patch prior to them pouring it. When I arrived, the hole was already framed in with plywood and the concrete was poured. Photos of the work are attached.
Sanitary Sewer Construction Inspection Partial 04/22/2019
Misc
Informational
04/22/2019
The City of Lee’s Summit Water Utilities department sent over the results from their camera and sewer bond inspection. The Redford crew is on site making the corrections to the sanitary sewer line per the bond inspection. The crew dug up the sag and made repairs to it, then they had their camera crew come out and inspect the line. They are backfilling the trench now and the 30 day wait will start today 4/22/2019. I will return later today for further inspection of the manholes.
Pavement-Stabilized Subgrade Partial 5/17/2019 05/17/2019
Misc
Informational
05/17/2019

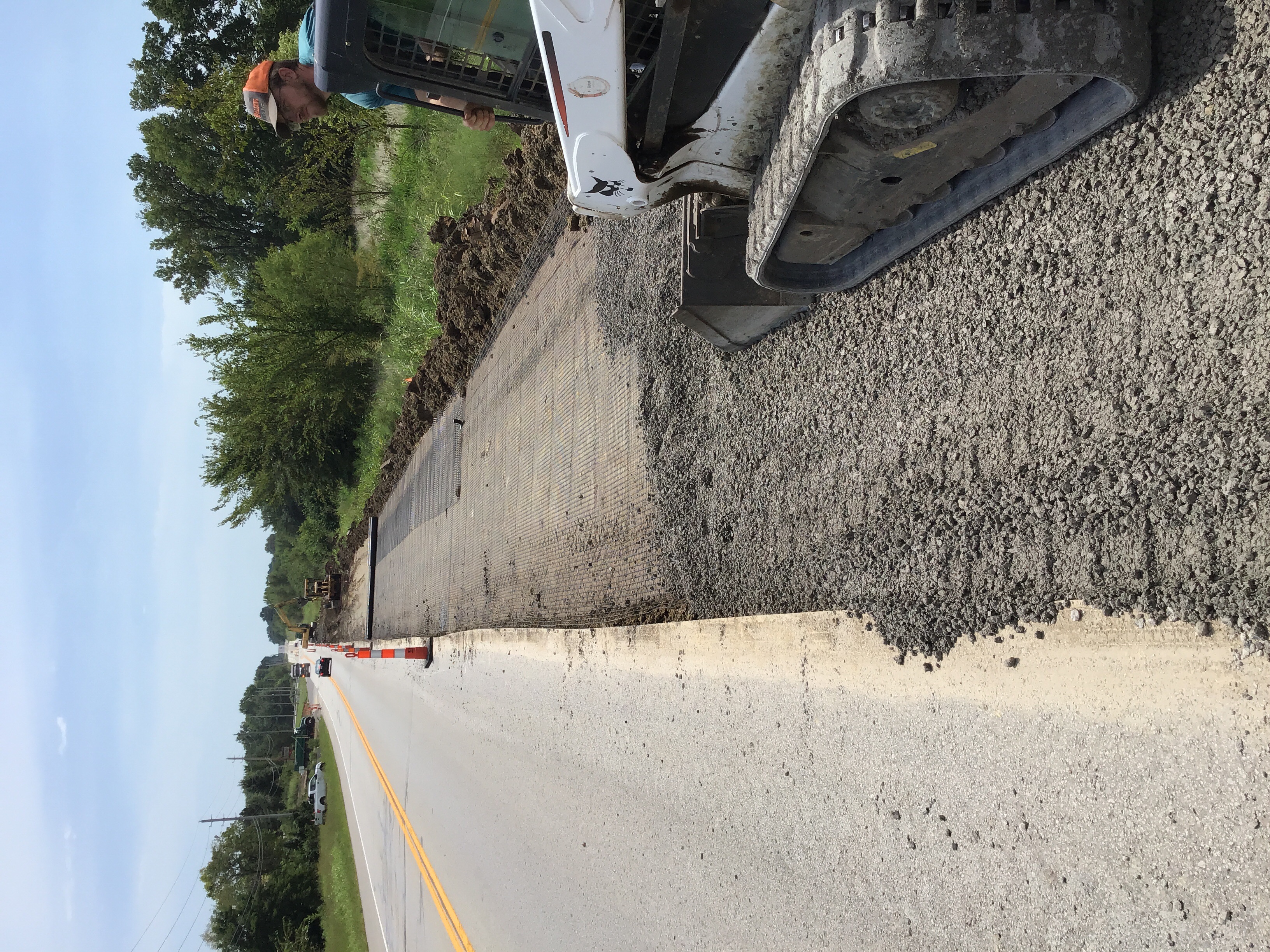

Randy Spalding Excavating is onsite installing the FlyAsh subgrade stabilization for the streets. KC Testing Lab is also onsite performing the density compaction testing.
Pavement-Proof Roll Partial 06/04/2019
Misc
Informational
06/04/2019
Randy Spalding Excavation proof rolled the street for the Fly Ash treated subgrade that was installed two weeks ago. The crew plans to install base rock today and will call for another proof roll at a later date.
Curb - Proof Roll Passed 06/10/2019
Misc
Informational
06/10/2019

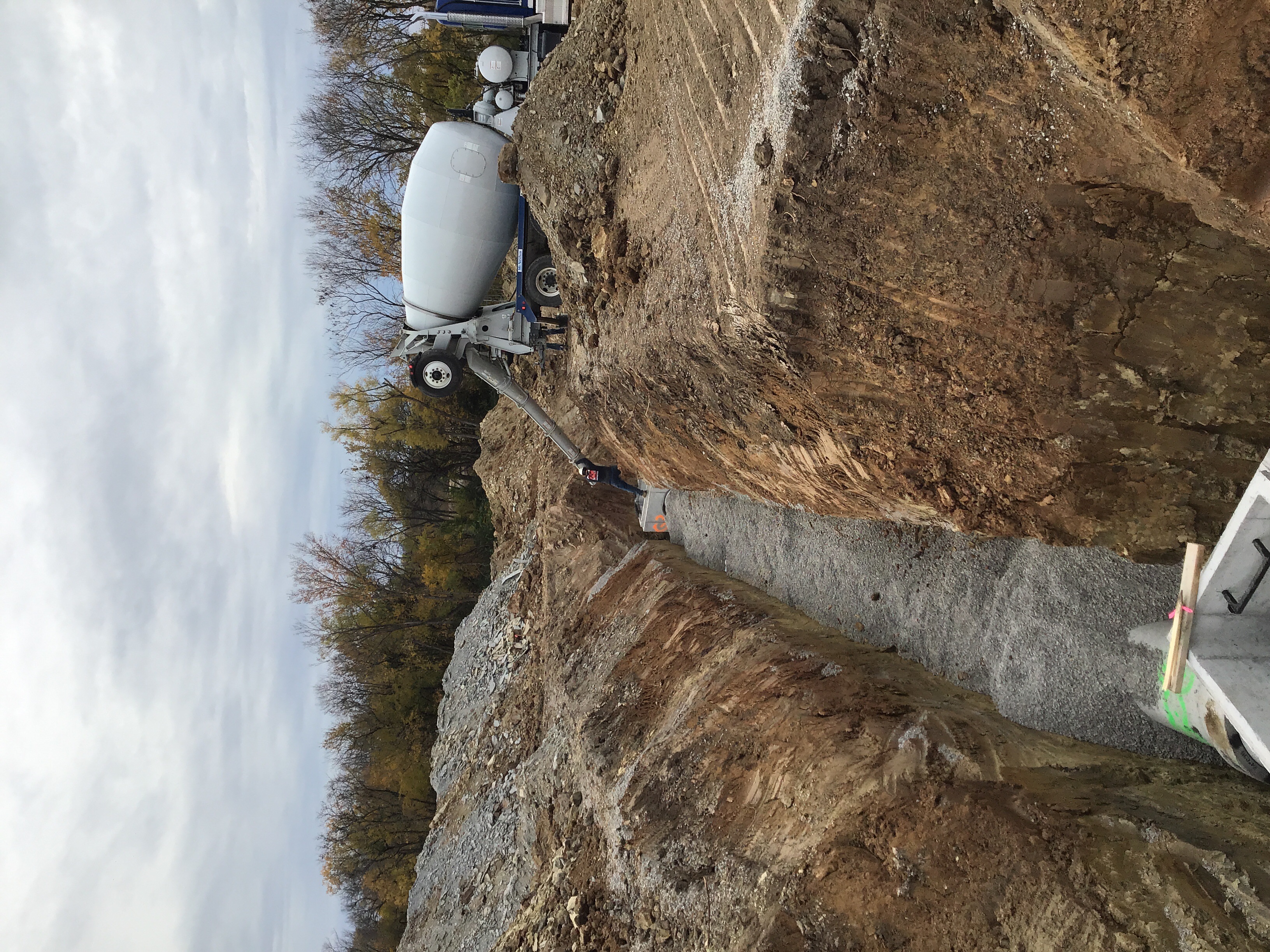

Randy Spalding Excavating performed the proof roll for the curb. I verified the load weight was 20 Ton and observed the roll test. Test Passed.
Public Curb Inspection Partial 6/13/2019 06/13/2019
Misc
Informational
06/13/2019
Ray Cochran Concrete installed a portion of the public curb. I verified the concrete mix type was KCMMB and that the install met the City of LS standard specs. Photos are attached.
Public Curb Inspection Partial 6/17/2019 06/17/2019
Misc
Informational
06/13/2019
Ray Cochran Concrete installed a portion of the public curb. I verified the concrete mix type was KCMMB and that the install met the City of LS standard specs. Photos are attached.
Misc
Informational
06/17/2019
Ray Cochran Concrete crew is on site installing the public road curbs. KC Testing Lab is also on site testing the slump, air and strength. They will provide me with the results. I will return for further inspection later today.
Public Curb Inspection Partial 6/17/2019 06/17/2019
Misc
Informational
06/17/2019
Ray Cochran Concrete installed a portion of the public curb. I verified the concrete mix type was KCMMB and that the install met the City of LS standard specs. Photos are attached.
Misc
Informational
06/17/2019
Ray Cochran Concrete crew is on site installing the public road curbs. KC Testing Lab is also on site testing the slump, air and strength. They will provide me with the results. I will return for further inspection later today.
Misc
Informational
06/17/2019
Ray Cochran Concrete crew is on site continuing the install of the public road curbs. I verified concrete type and that the install meets the City standards and matches the approved plans.
Pavement-Proof Roll Partial 06/20/2019
Misc
Informational
06/04/2019
Randy Spalding Excavation proof rolled the street for the Fly Ash treated subgrade that was installed two weeks ago. The crew plans to install base rock today and will call for another proof roll at a later date.
Misc
Informational
06/20/2019
I observed the proof roll for the public curb section of the project that ties into the Hawthorne Elementary School. Roll test passed.
Pavement-Aggregate Base Passed 7/9/2019 07/09/2019
Misc
Informational
07/09/2019

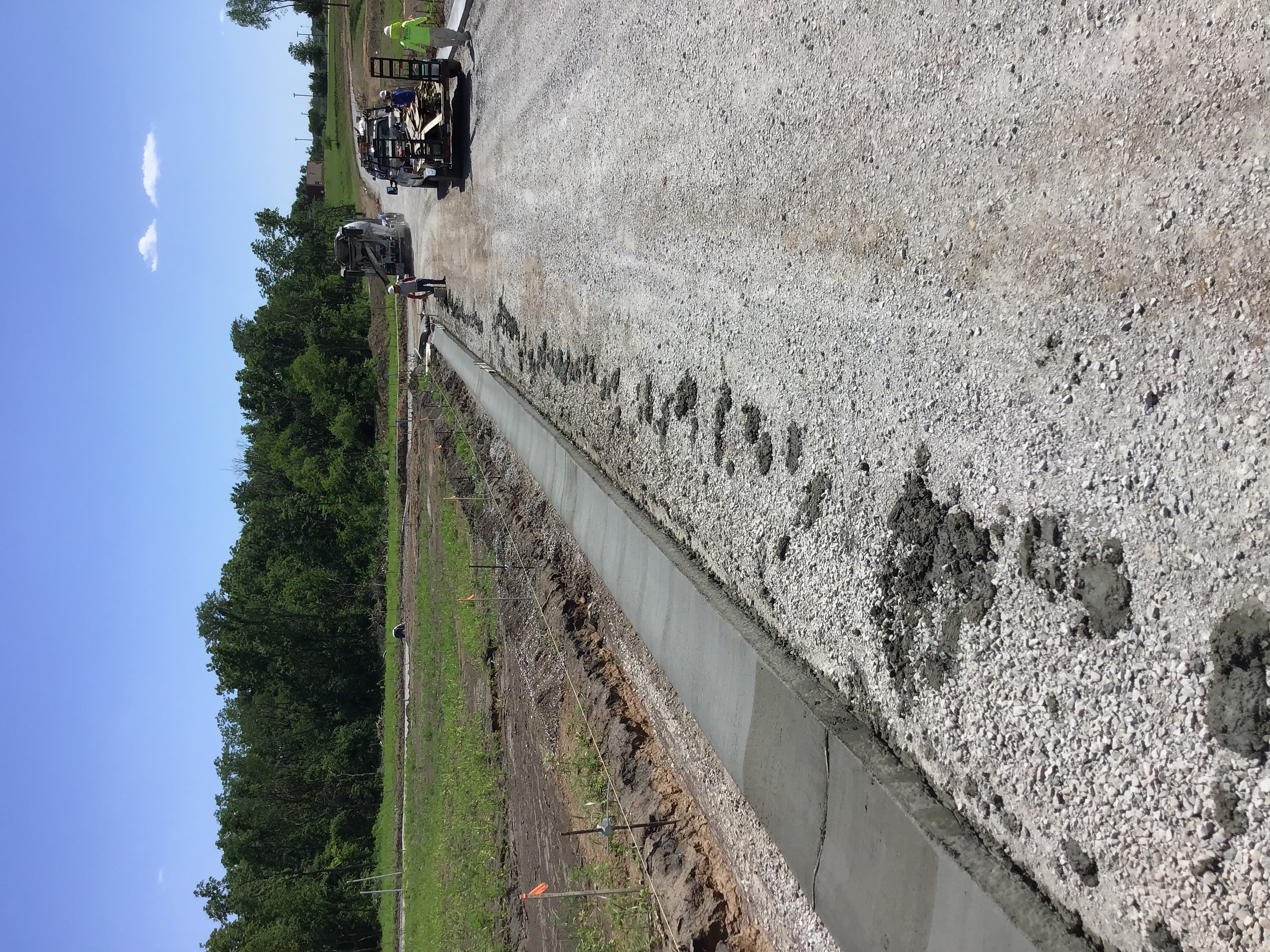

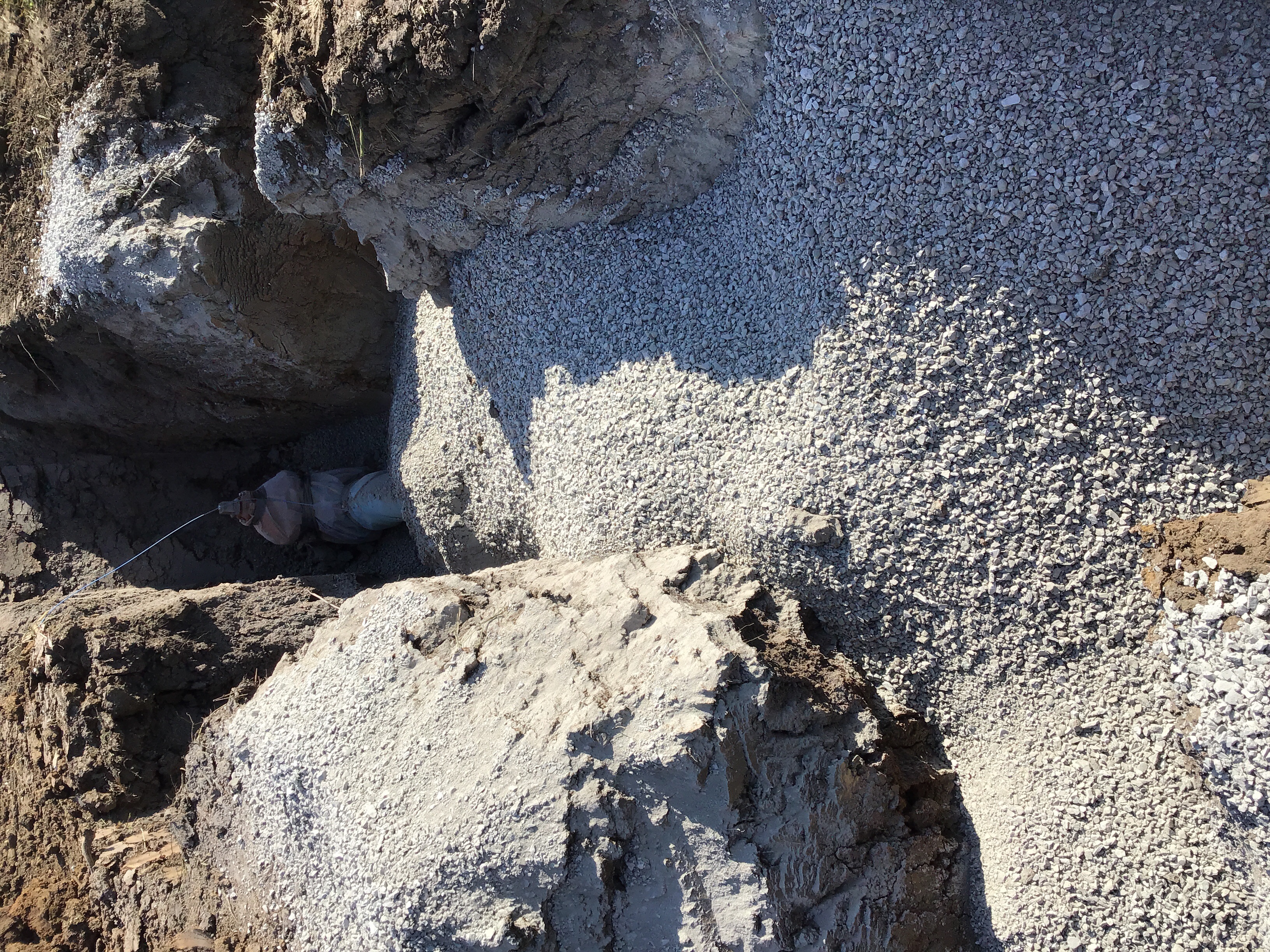

The Randy Spalding Excavation crew and I performed a grade depth check of the sub grade. Inspection Passed.
Pavement-Proof Roll Passed 7/9/2019 07/09/2019
Misc
Informational
06/20/2019
Randy Spalding Excavation proof rolled the street for the Fly Ash treated subgrade that was installed two weeks ago. The crew plans to install base rock today and will call for another proof roll at a later date.
Misc
Informational
06/20/2019
I observed the proof roll for the public curb section of the project that ties into the Hawthorne Elementary School. Roll test passed.
Misc
Informational
07/09/2019

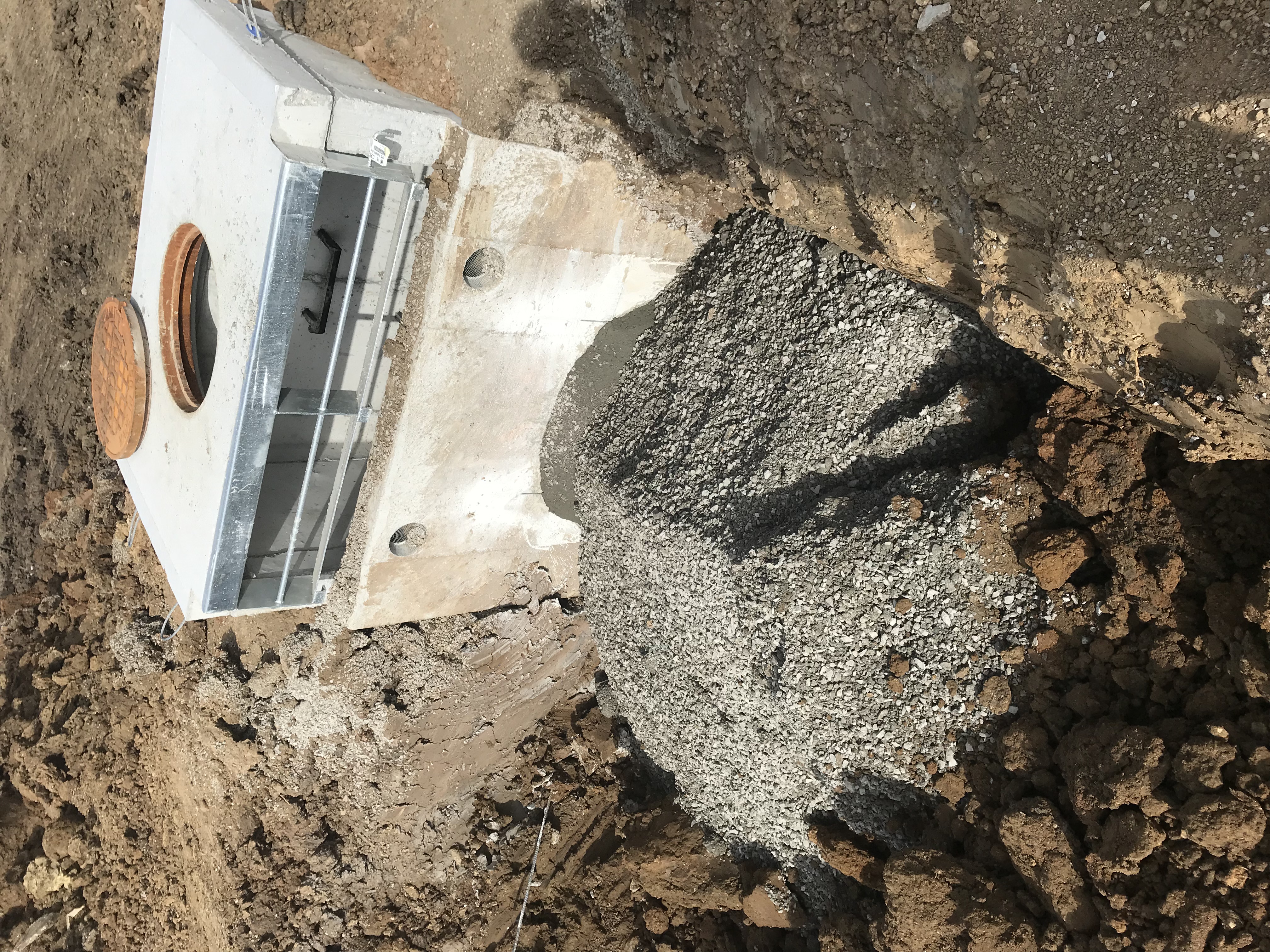

Base rock was installed and allowed to cure out. I observed the Randy Spalding Excavation crew perform the proof roll for the public streets of the project. I verified the correct Truck and load weight on the truck. Proof roll passed. The Calverts Paving crew plans to start laying the base asphalt lift at 6:30 AM Wednesday 7/10/19.

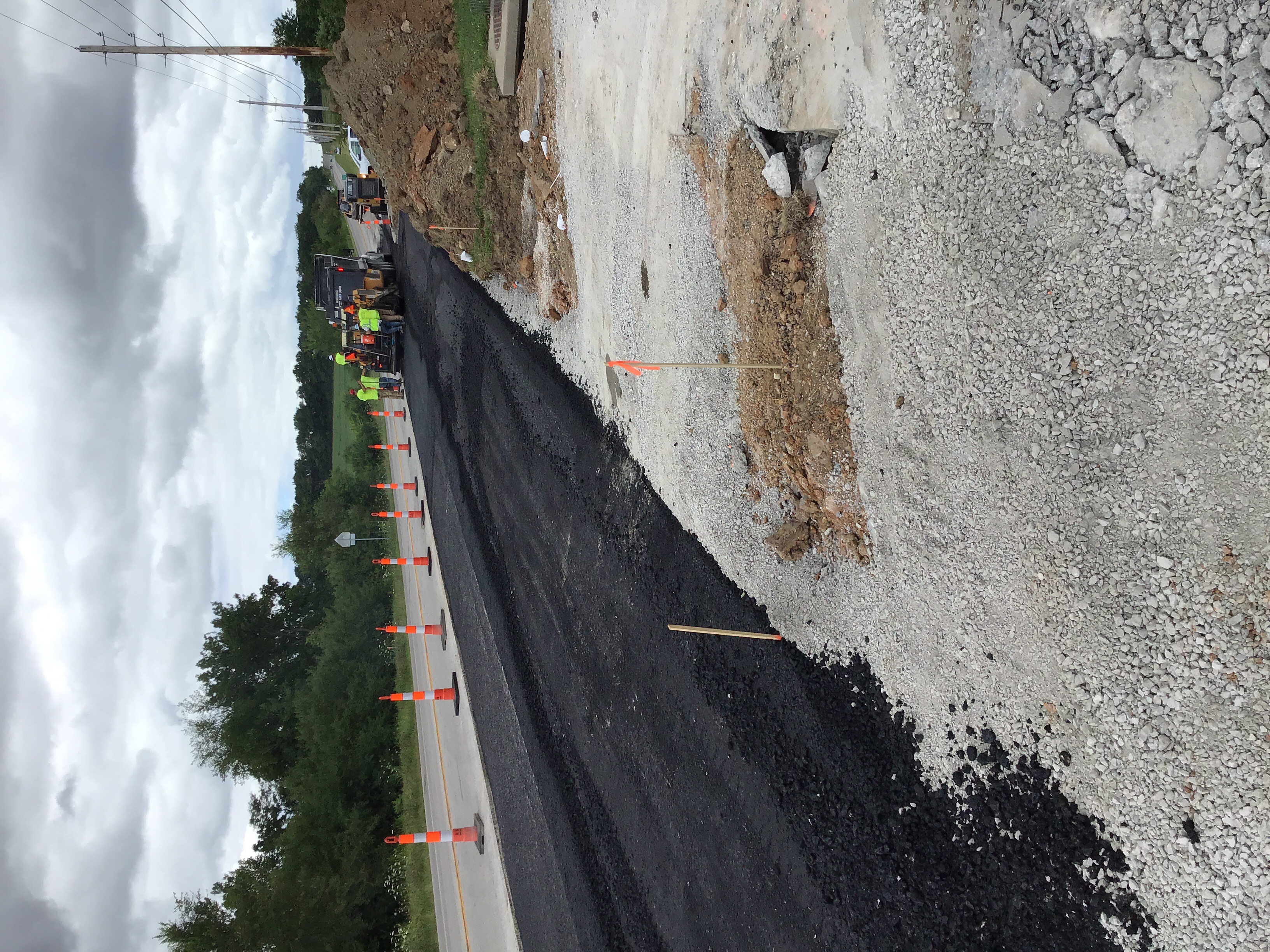

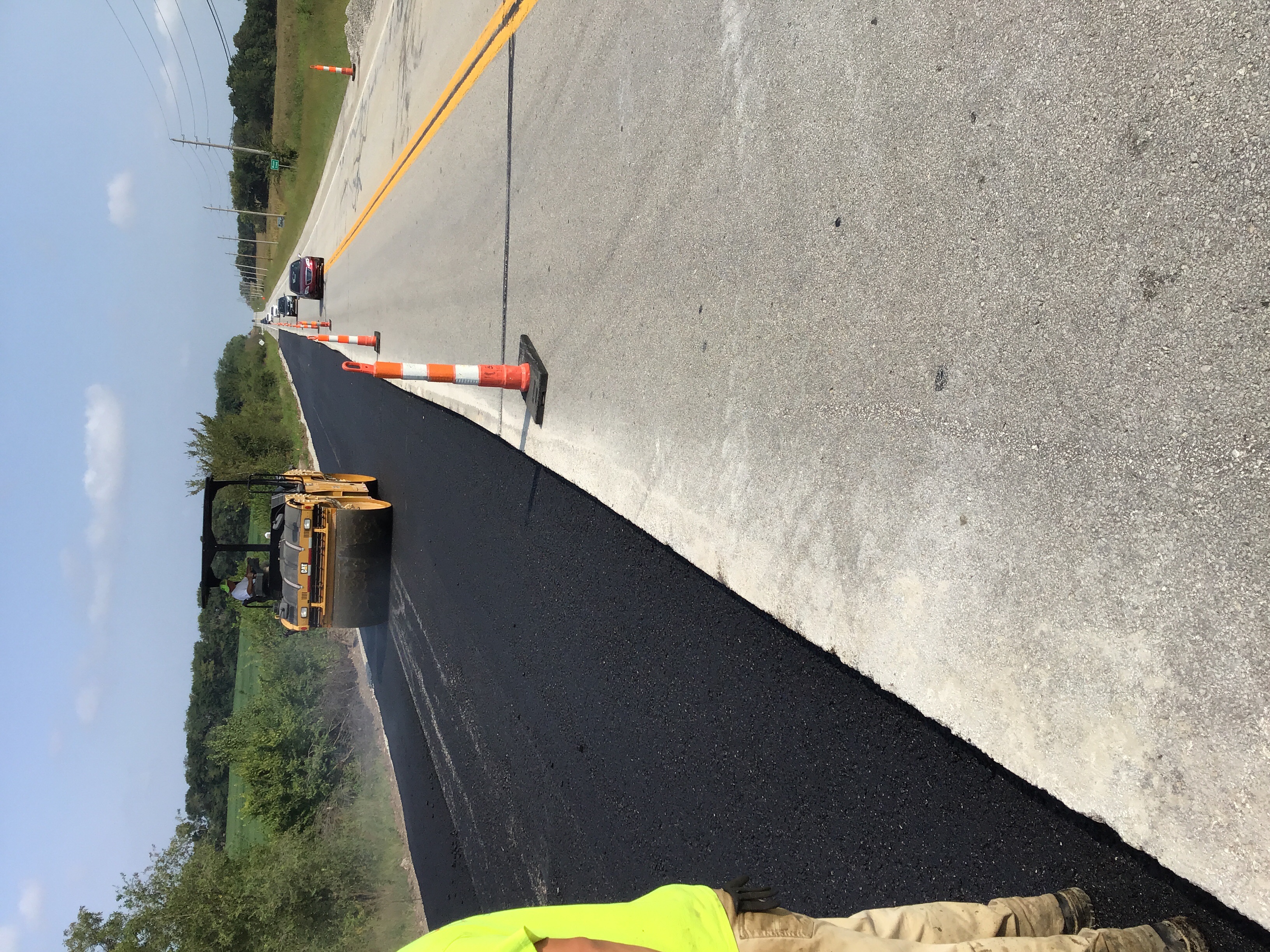

Pavement-Surface Partial 7/10/2019 07/10/2019
Misc
Informational
07/10/2019

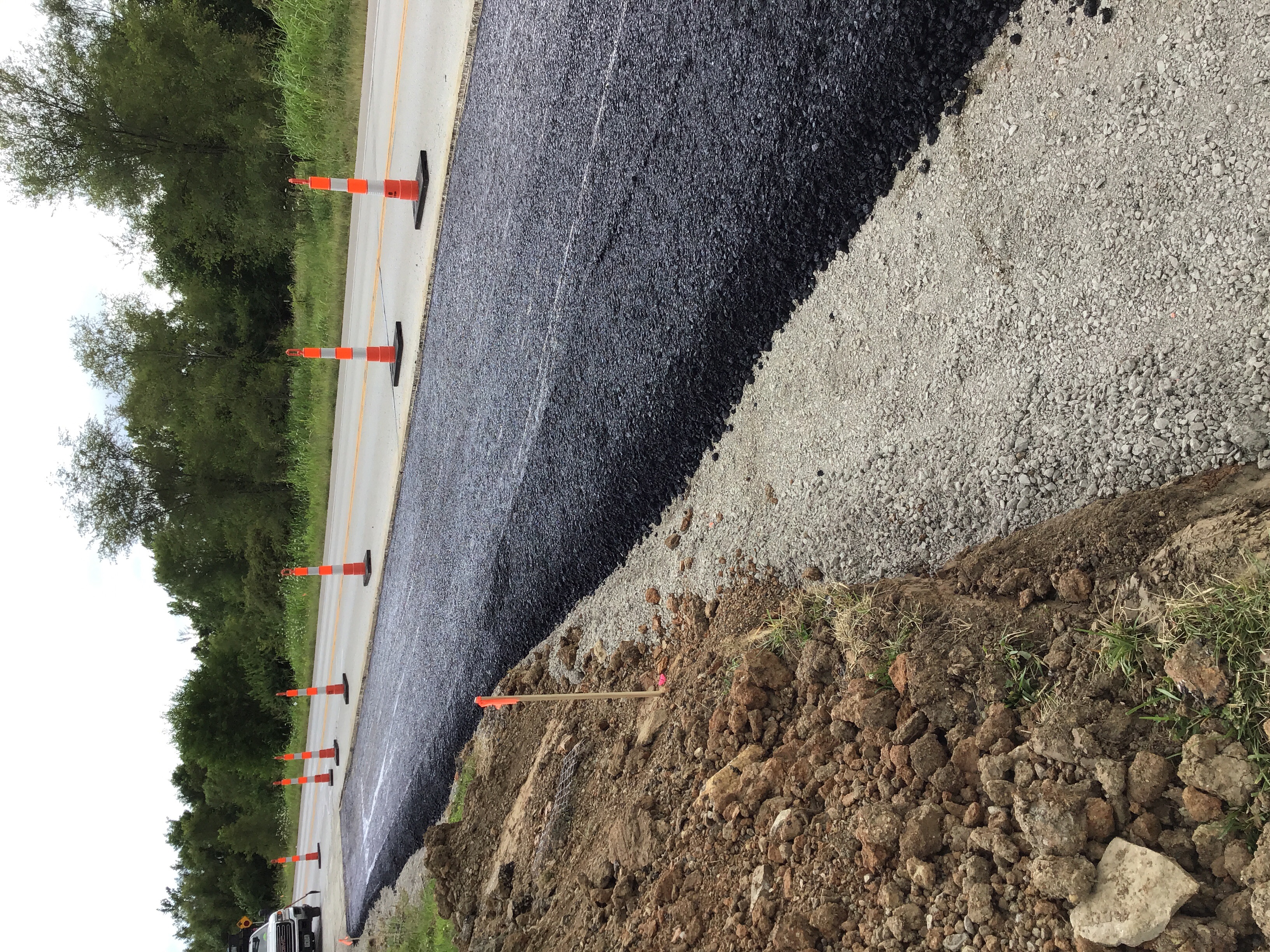

On site inspection for the asphalt base lift. Calverts Paving is installing the base lift for the project. I verified the correct mix type and temperatures. KC Testing Lab is on site running density tests and will provide us with the results.
Street - Wedge Lift Partial 7/11/2019 07/11/2019
Misc
Informational
07/11/2019
The RandySpalding crew is working on the Pryor Rd. right turn lane widening. The crew has the shoulder cut out and to grade. The crew installed geo-grid and base rock. After the base rock cures out we will proof roll prior to paving. Photos are attached.
Pavement-Surface Passed 7/11/2019 07/11/2019
Misc
Informational
07/10/2019
On site inspection for the asphalt base lift. Calverts Paving is installing the base lift for the project. I verified the correct mix type and temperatures. KC Testing Lab is on site running density tests and will provide us with the results.
Misc
Informational
07/11/2019
Calverts Paving completed the base lift for the subdivision this afternoon. I was on site and verified the correct mix type and that the temperatures were correct. The crew started on the surface lift and plans to complete it tomorrow.
Street - Surface Course Partial 07/11/2019
Misc
Informational
07/11/2019
The Calverts Paving crew started the surface install this afternoon. The crew started at the north end of SW River Run Drive and laid asphalt to approximately station 13+00. The crew plans to finish the install tomorrow. I verified the correct mix type and temperature of the asphalt being installed.
Street - Surface Course Passed 7/12/2019 07/12/2019
Misc
Informational
07/11/2019
The Calverts Paving crew started the surface install this afternoon. The crew started at the north end of SW River Run Drive and laid asphalt to approximately station 13+00. The crew plans to finish the install tomorrow. I verified the correct mix type and temperature of the asphalt being installed.
Misc
Informational
07/12/2019

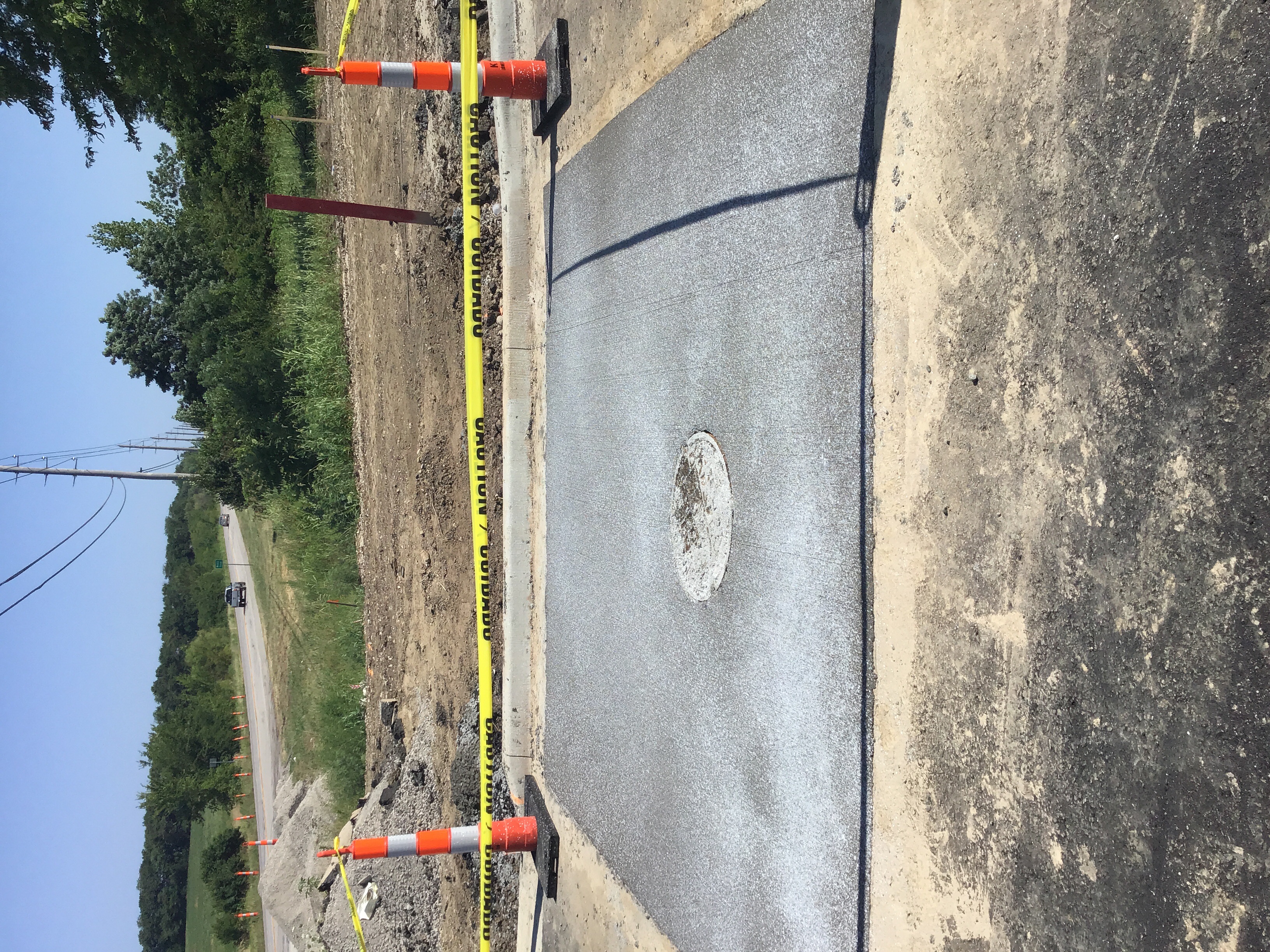

Calverts Paving completed the surface asphalt lift for the project. I verified the correct asphalt mix type, temperature and equipment used during the install.
Street - Wedge Lift Partial 7/12/2019 07/12/2019
Misc
Informational
07/11/2019
The RandySpalding crew is working on the Pryor Rd. right turn lane widening. The crew has the shoulder cut out and to grade. The crew installed geo-grid and base rock. After the base rock cures out we will proof roll prior to paving. Photos are attached.
Misc
Informational
07/12/2019
The crew continued with the Pryor road right turn lane. Additional base rock was installed and the area is cut to grade. Plans are to install asphalt first early next week.
Street - Wedge Lift Partial 7/15/2019 07/15/2019
Misc
Informational
07/12/2019
The RandySpalding crew is working on the Pryor Rd. right turn lane widening. The crew has the shoulder cut out and to grade. The crew installed geo-grid and base rock. After the base rock cures out we will proof roll prior to paving. Photos are attached.
Misc
Informational
07/12/2019
The crew continued with the Pryor road right turn lane. Additional base rock was installed and the area is cut to grade. Plans are to install asphalt first early next week.
Misc
Informational
07/15/2019
I observed the proof roll for the Pryor Road right turn lane widening. I verified the correct load weight and truck type. Proof roll passed. The Calverts paving crew plans to lay asphalt today.
Street - Wedge Lift Partial 7/15/2019 07/15/2019
Misc
Informational
07/15/2019
The RandySpalding crew is working on the Pryor Rd. right turn lane widening. The crew has the shoulder cut out and to grade. The crew installed geo-grid and base rock. After the base rock cures out we will proof roll prior to paving. Photos are attached.
Misc
Informational
07/15/2019
The crew continued with the Pryor road right turn lane. Additional base rock was installed and the area is cut to grade. Plans are to install asphalt first early next week.
Misc
Informational
07/15/2019
I observed the proof roll for the Pryor Road right turn lane widening. I verified the correct load weight and truck type. Proof roll passed. The Calverts paving crew plans to lay asphalt today.
Misc
Informational
07/15/2019
Calverts Paving installed the base and surface lifts for the Pryor Rd. Right turn lane. I verified proper load and surface temps between lifts and the correct mix types according to the approved plans. The proper equipment is being used.

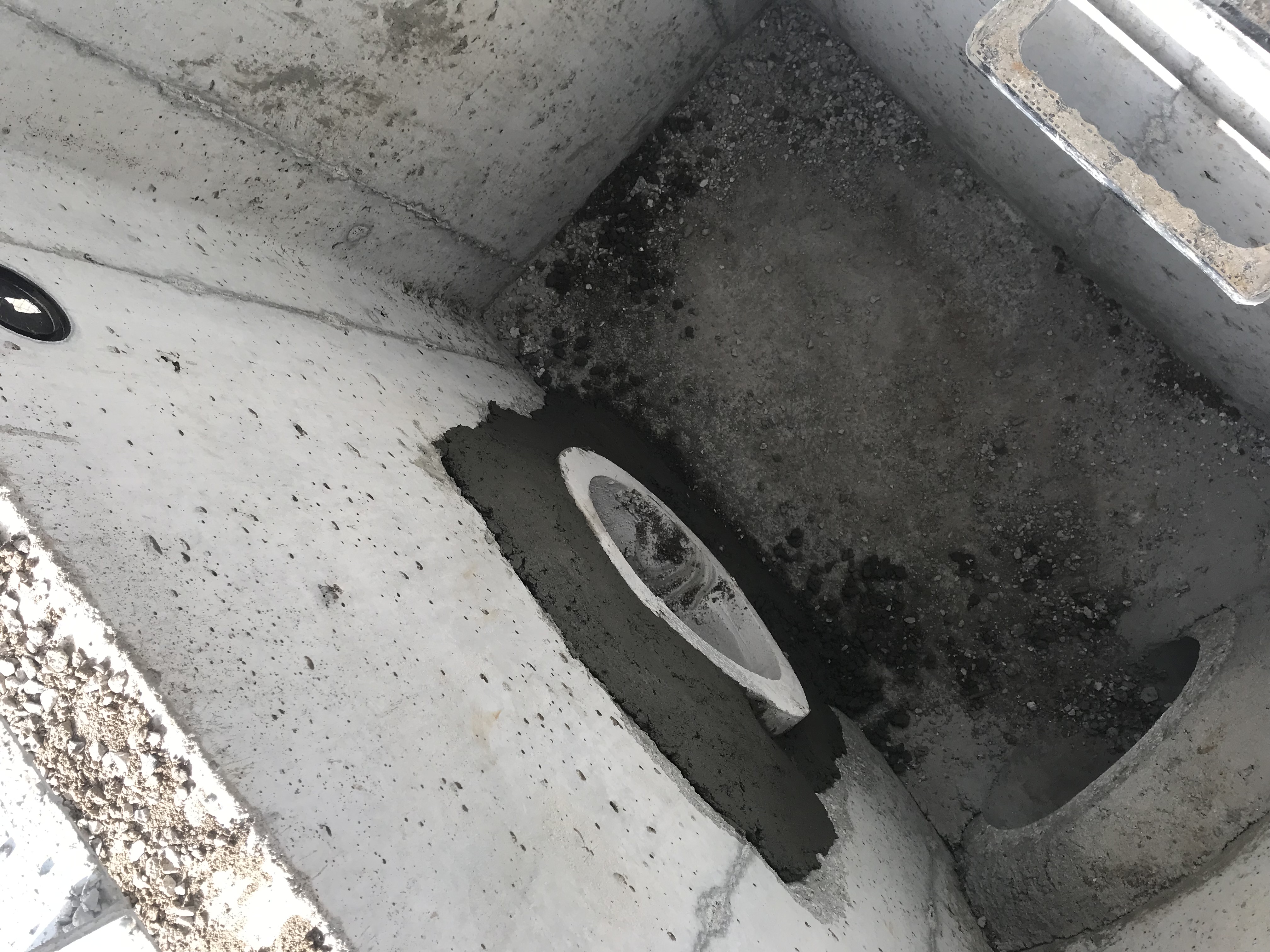

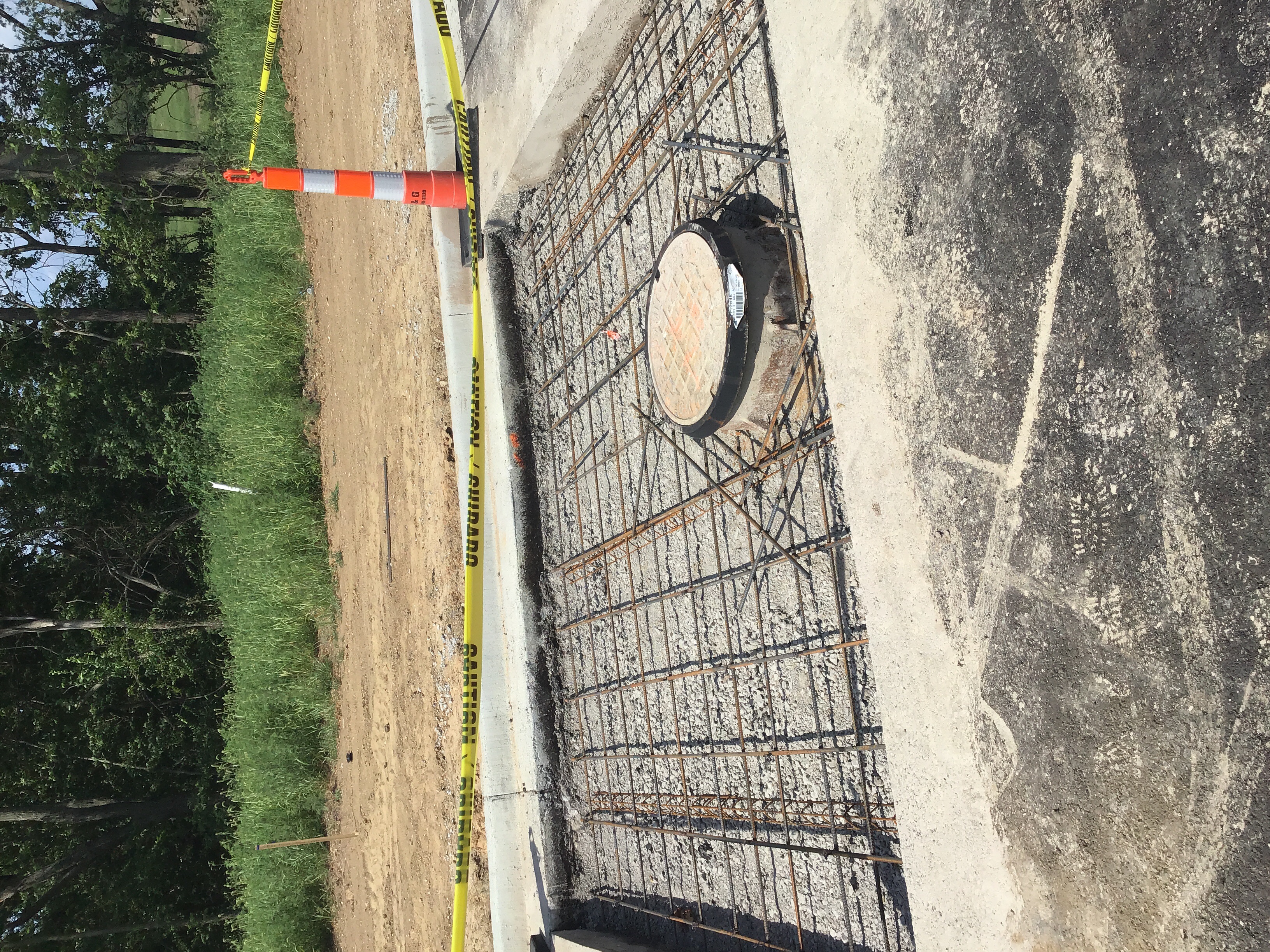

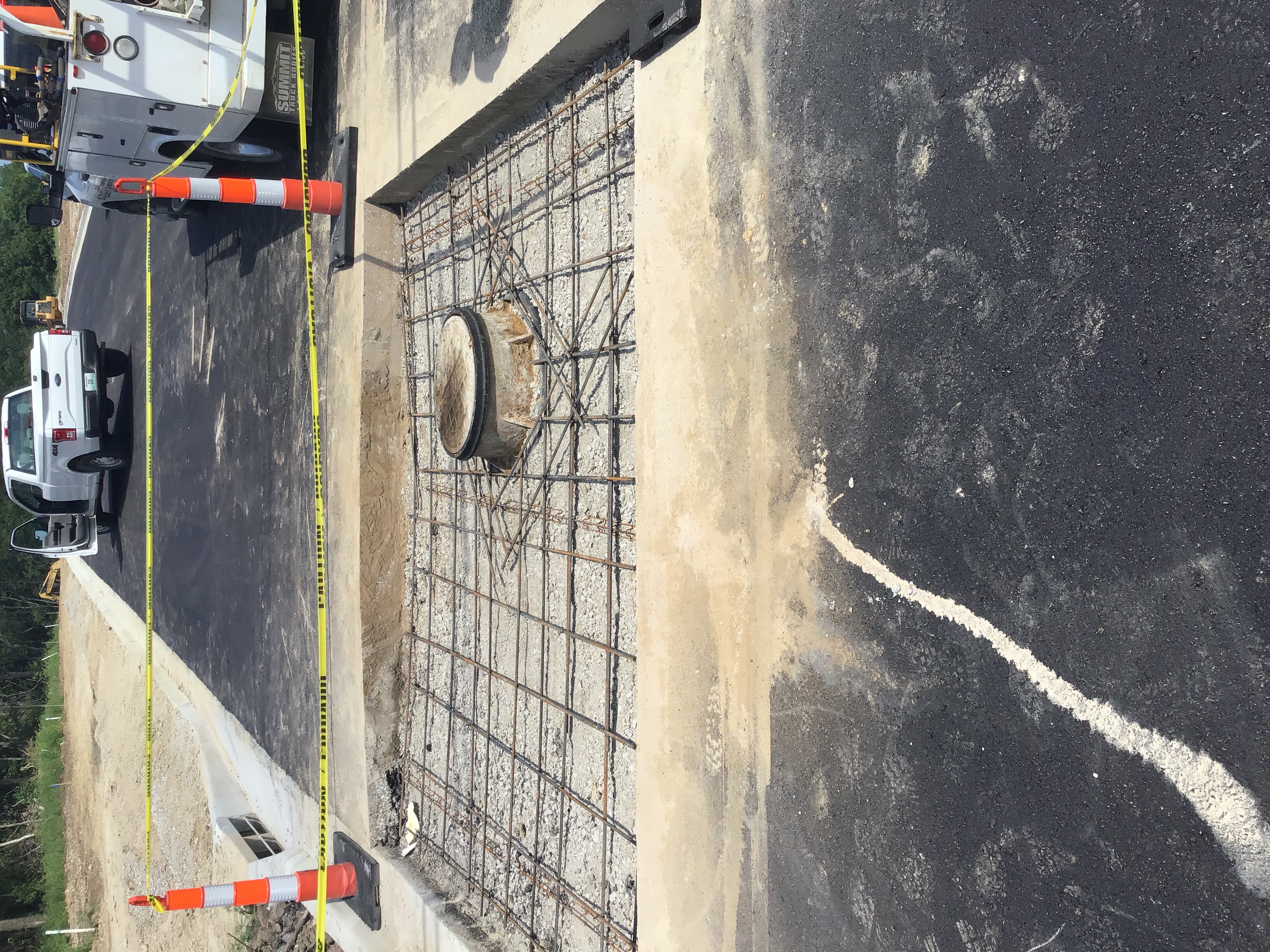

Street - Concrete Passed 07/18/2019
Misc
Informational
07/18/2019

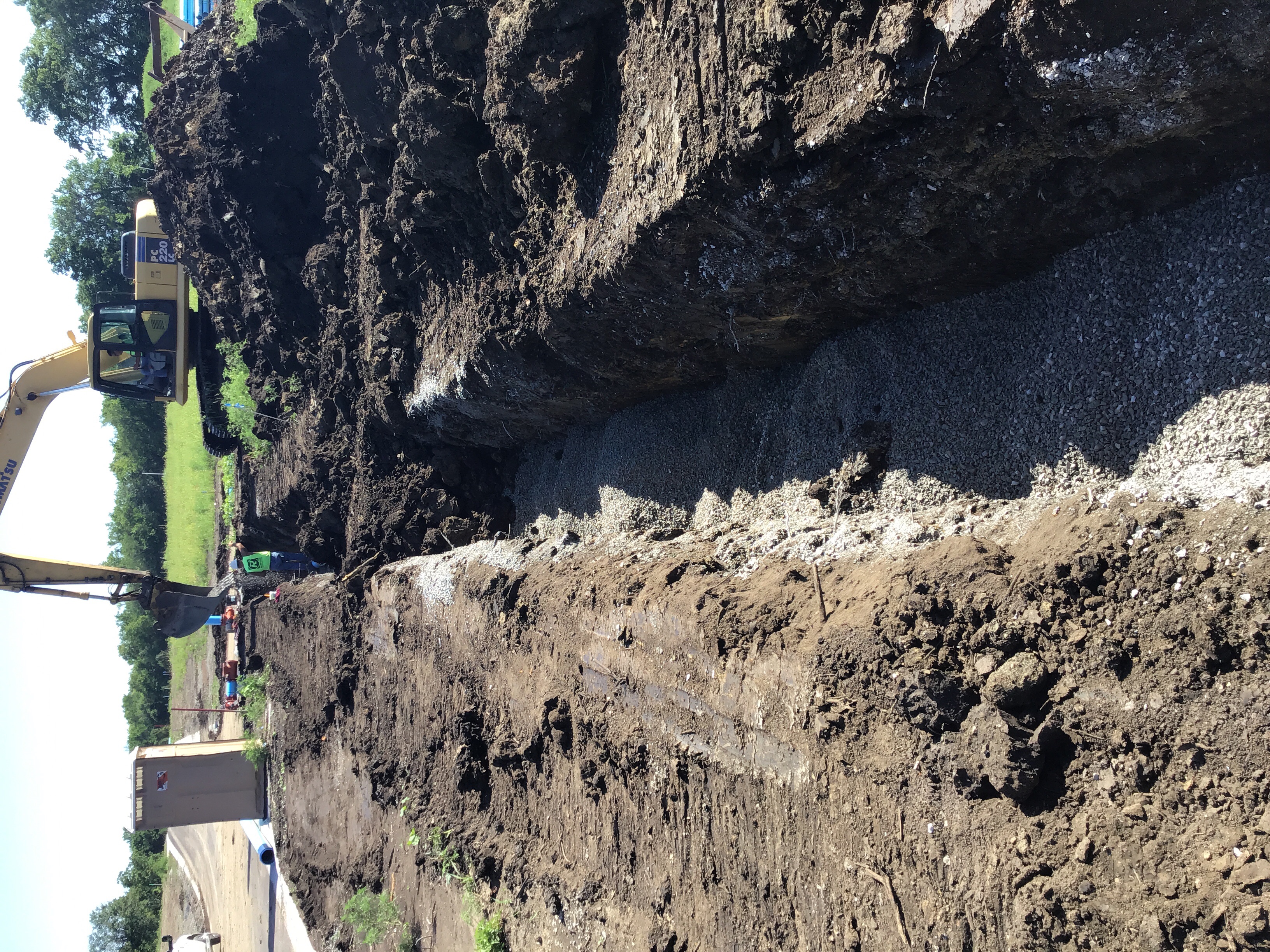

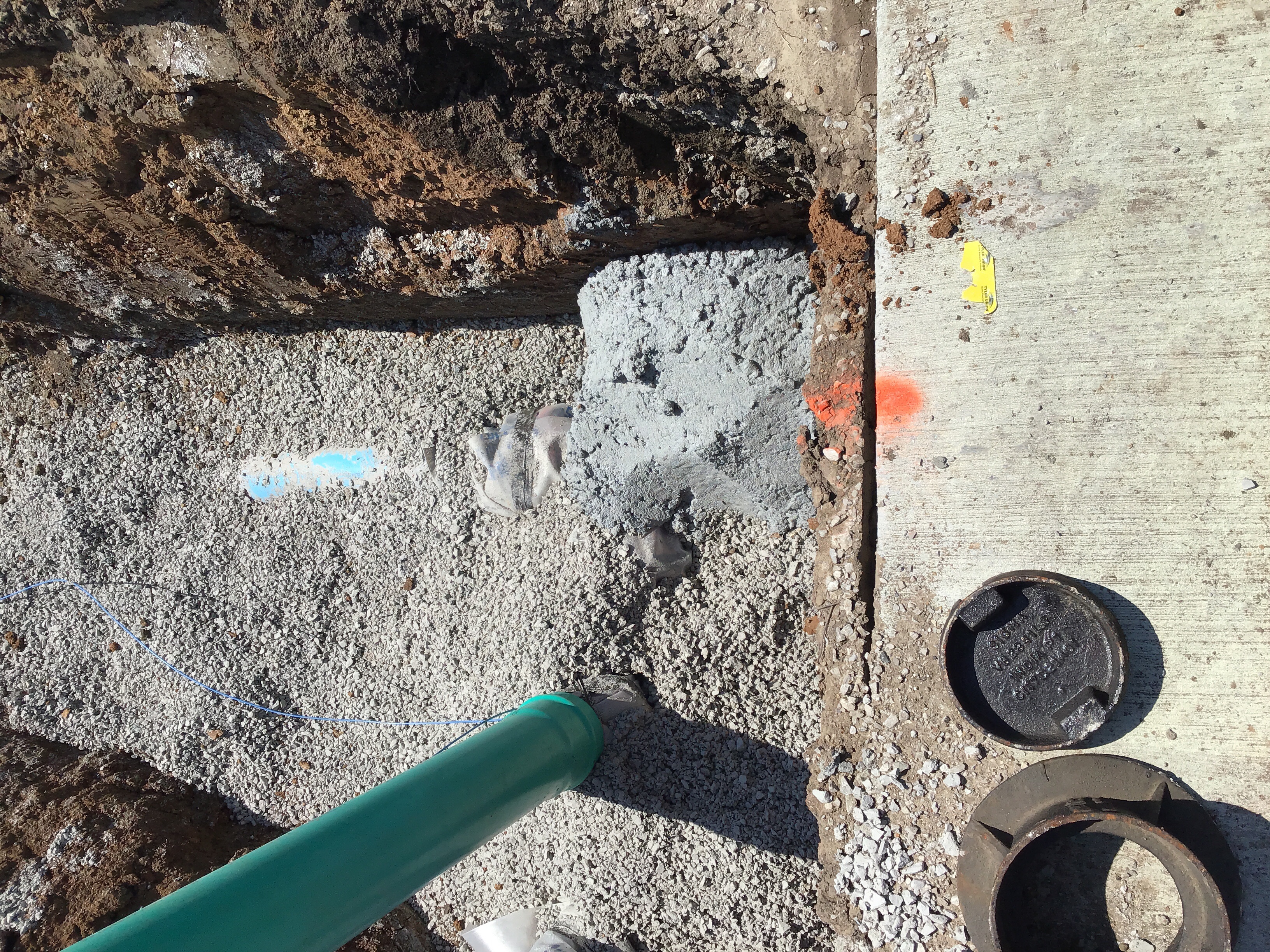

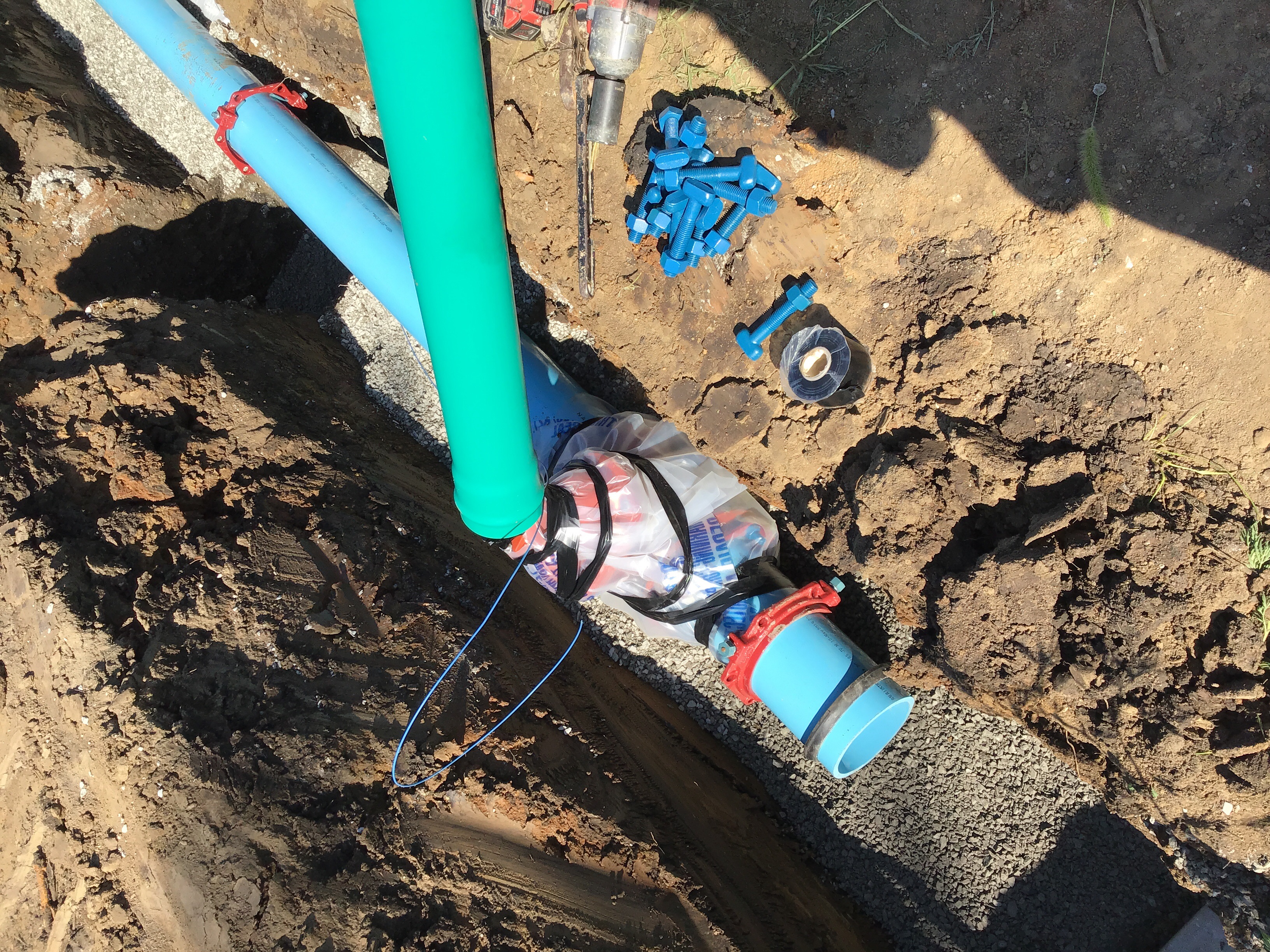

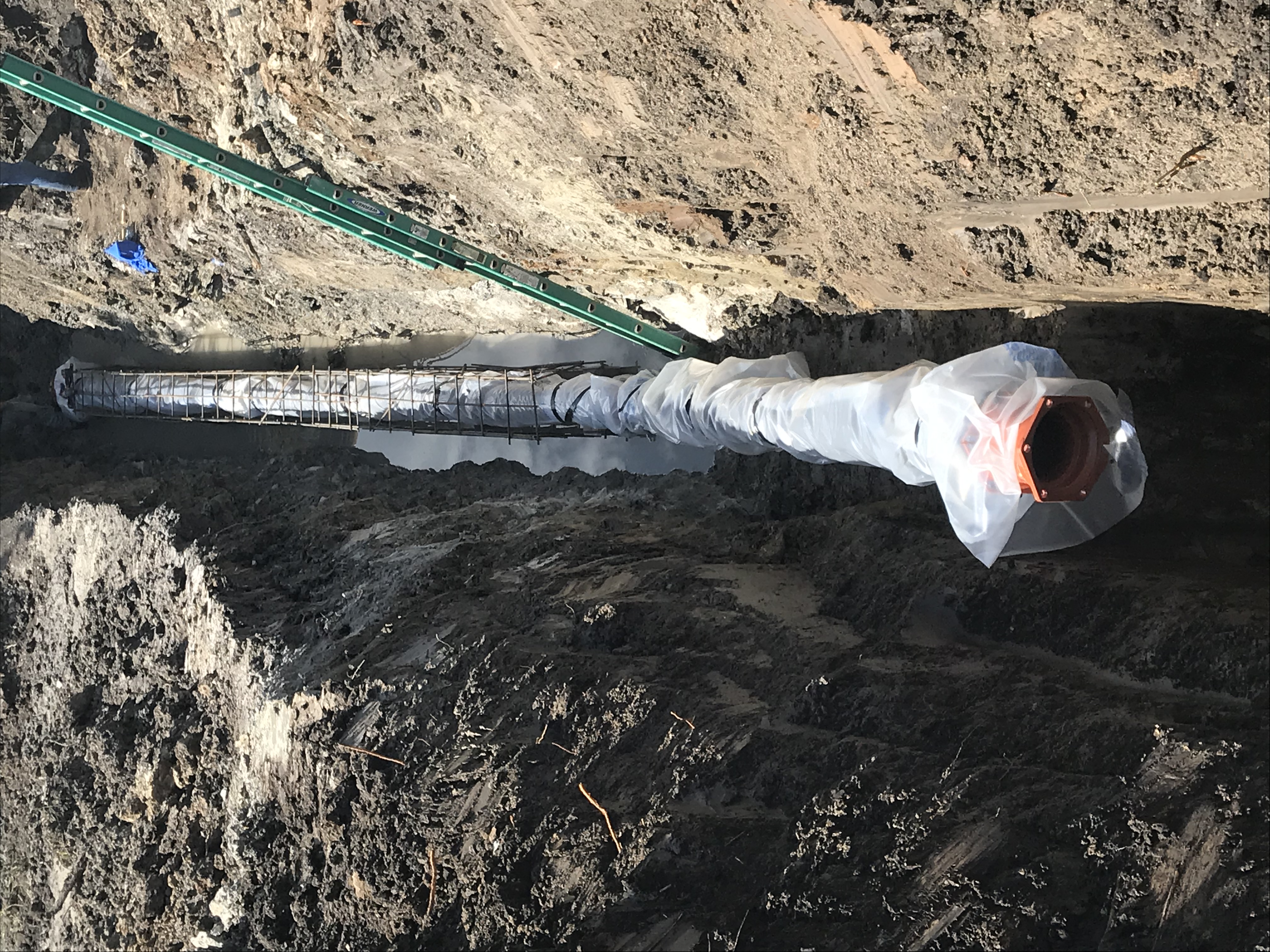

The Redford Construction formed up the concrete manhole collars for the two manholes in the paved drive lanes. The work appears to Meet the details provided in the approved plans. The crew plans to pour the concrete tomorrow morning 7-19-19. Photos are attached.
Water Line - Construction Inspection Partial 07/19/2019
Misc
Informational
07/19/2019

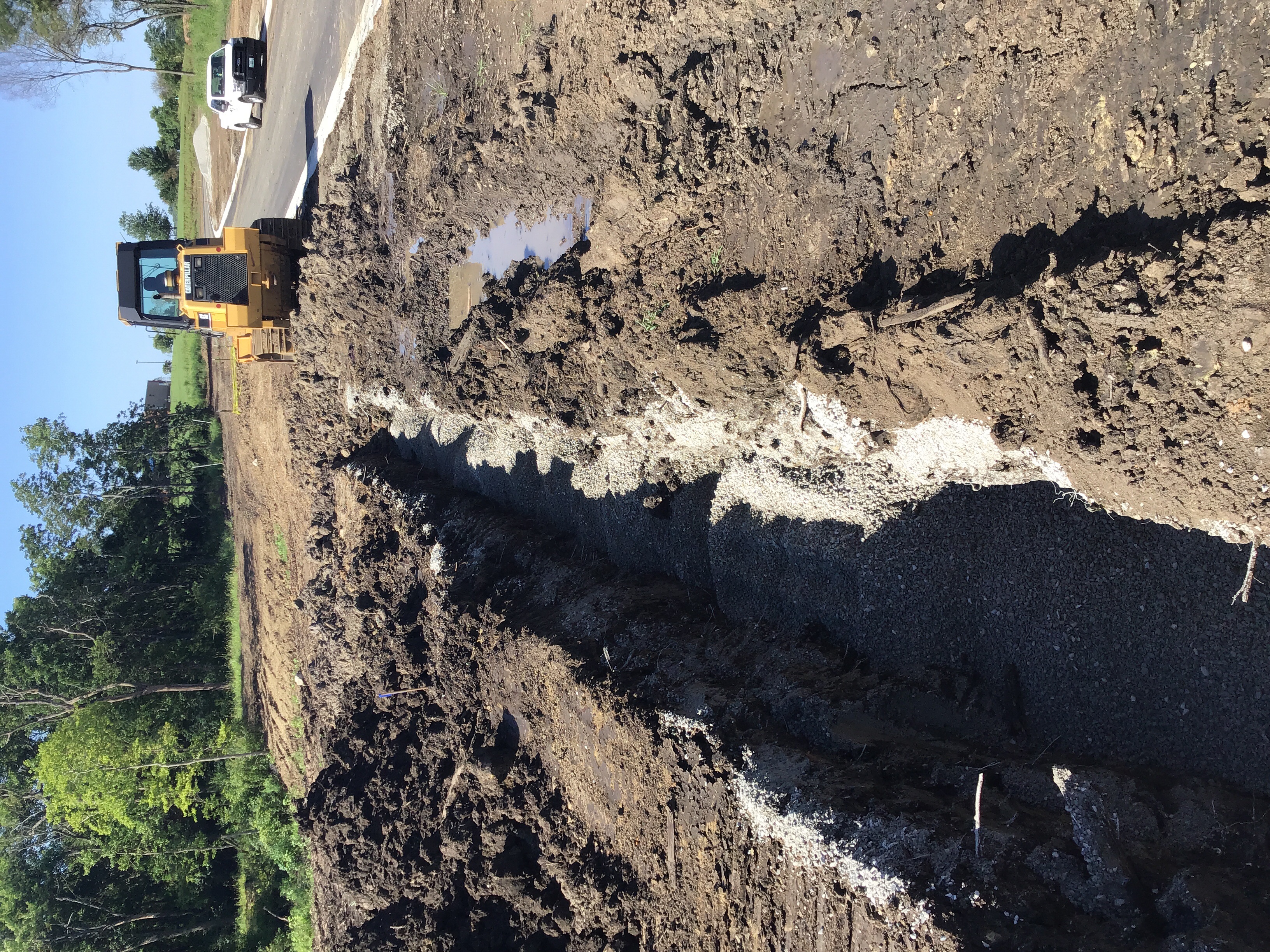

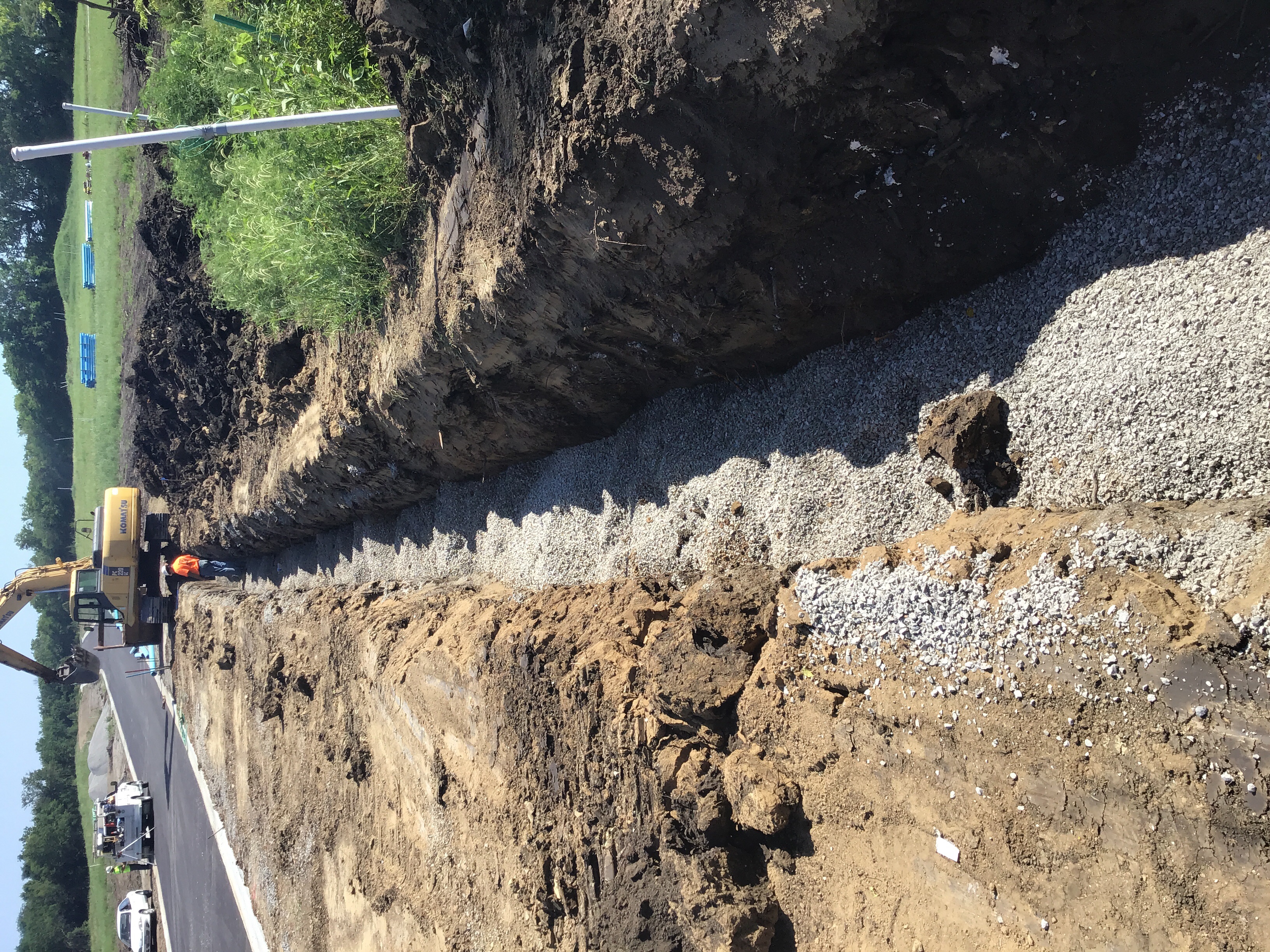

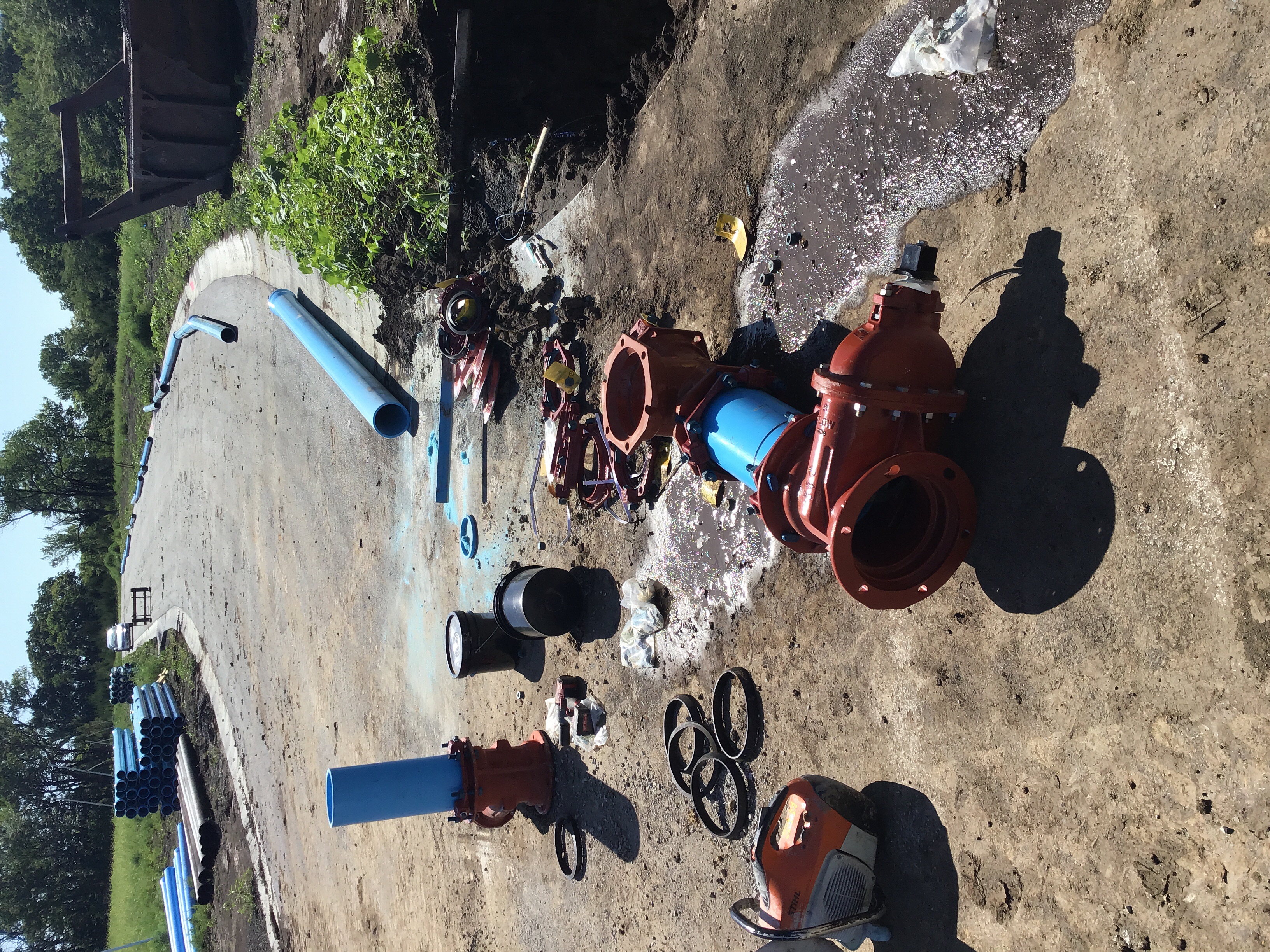

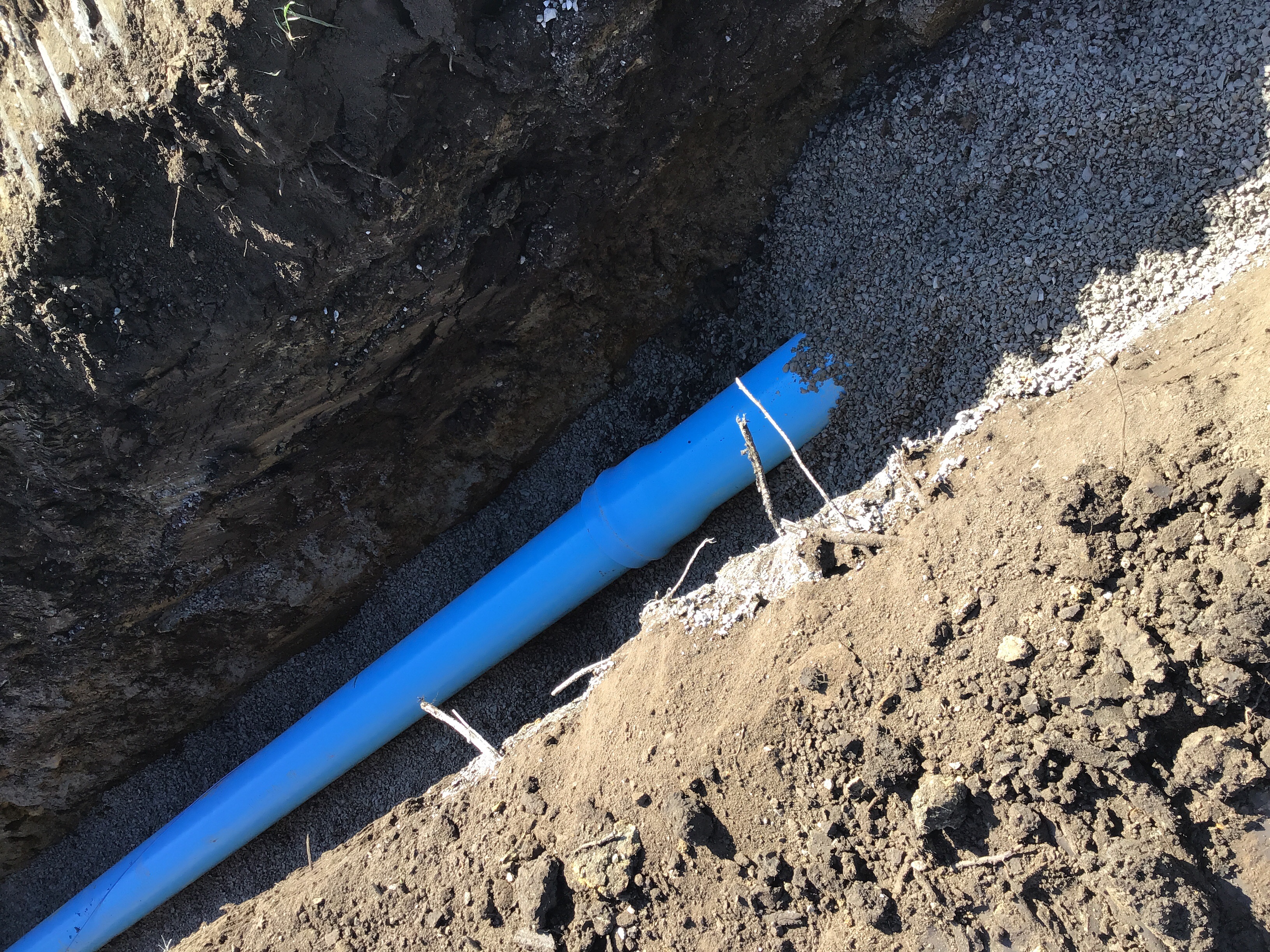

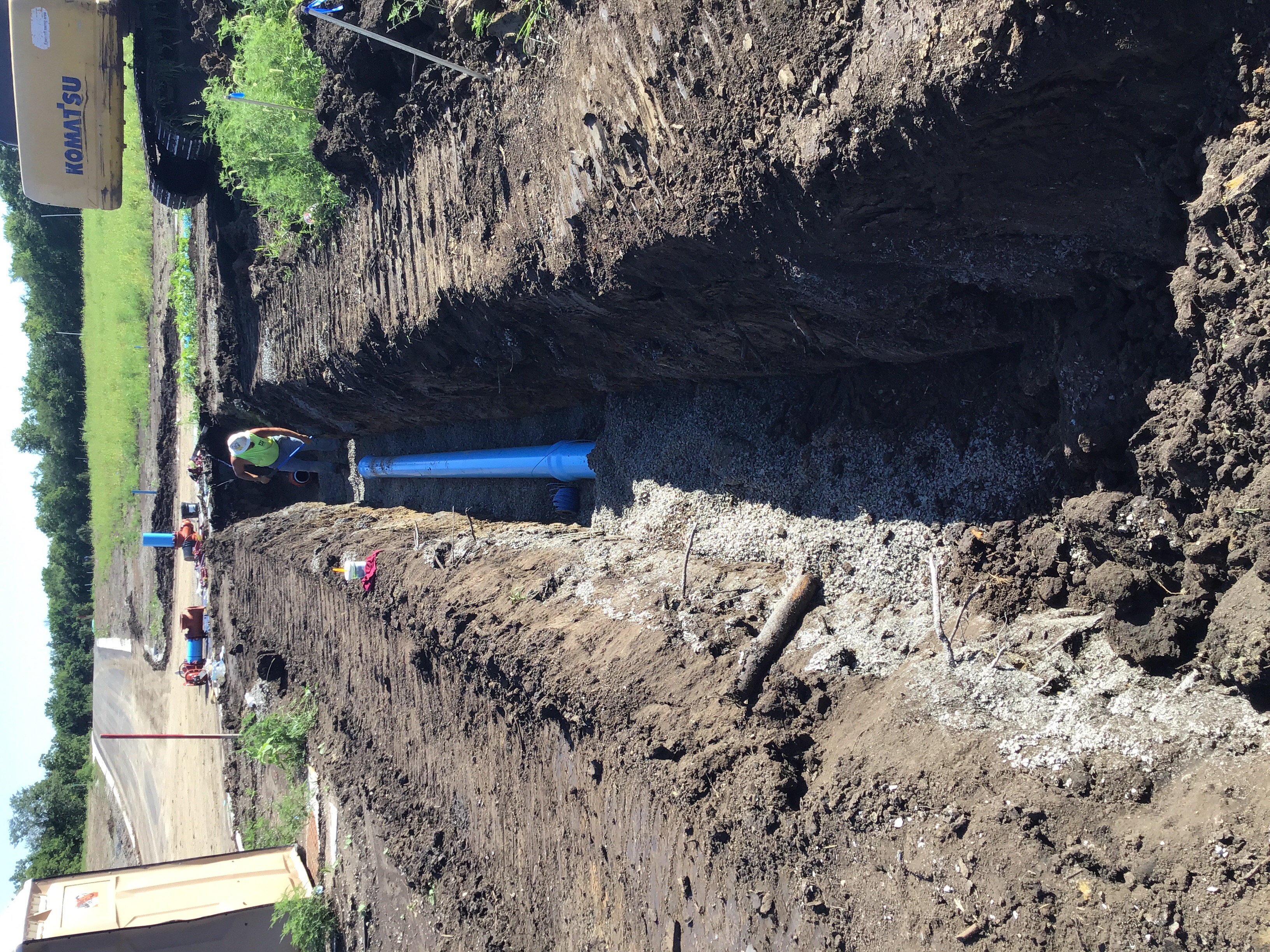

The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Water Line - Construction Inspection Partial 7/19/2019 07/19/2019
Misc
Informational
07/19/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/19/2019

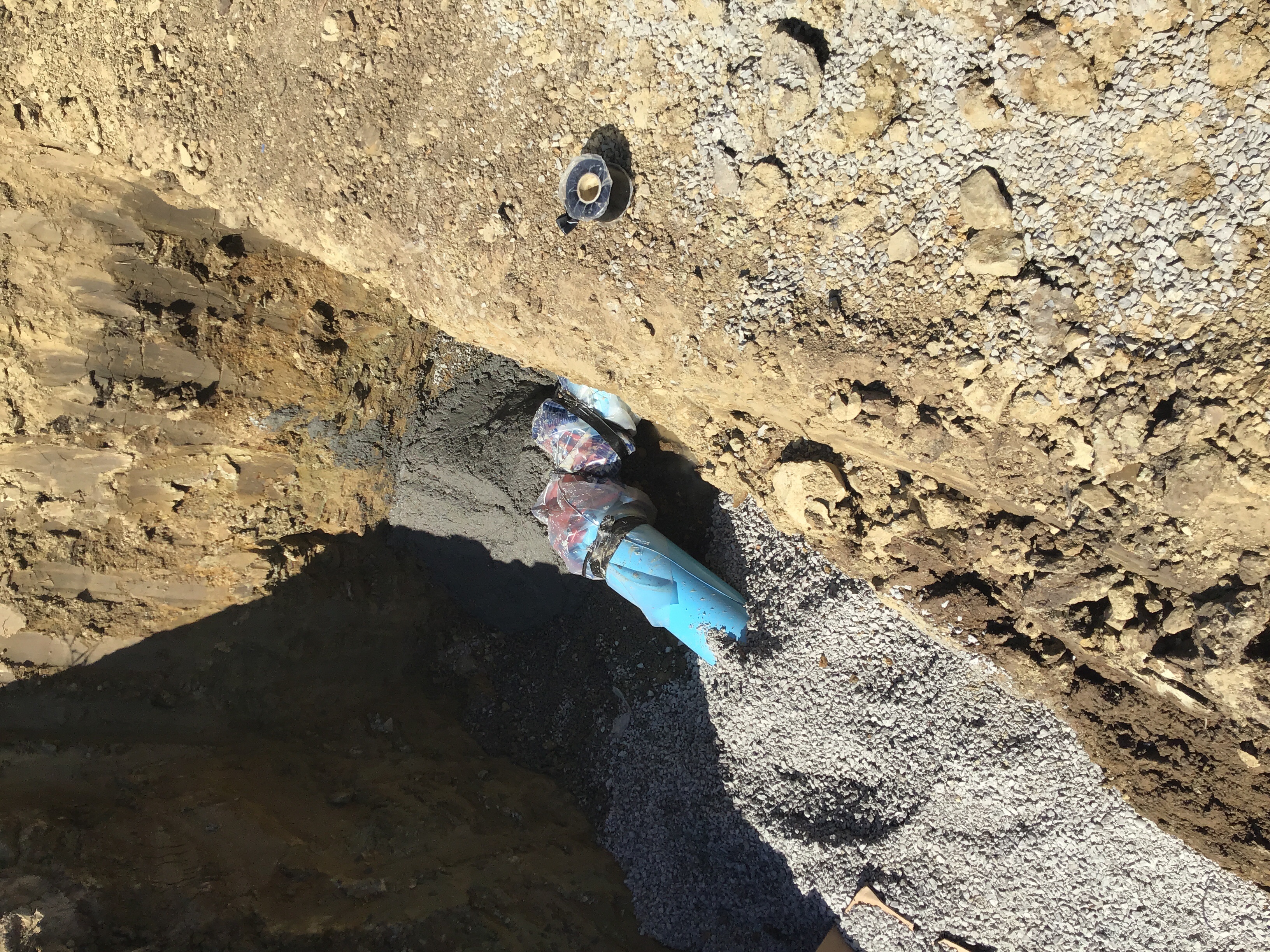

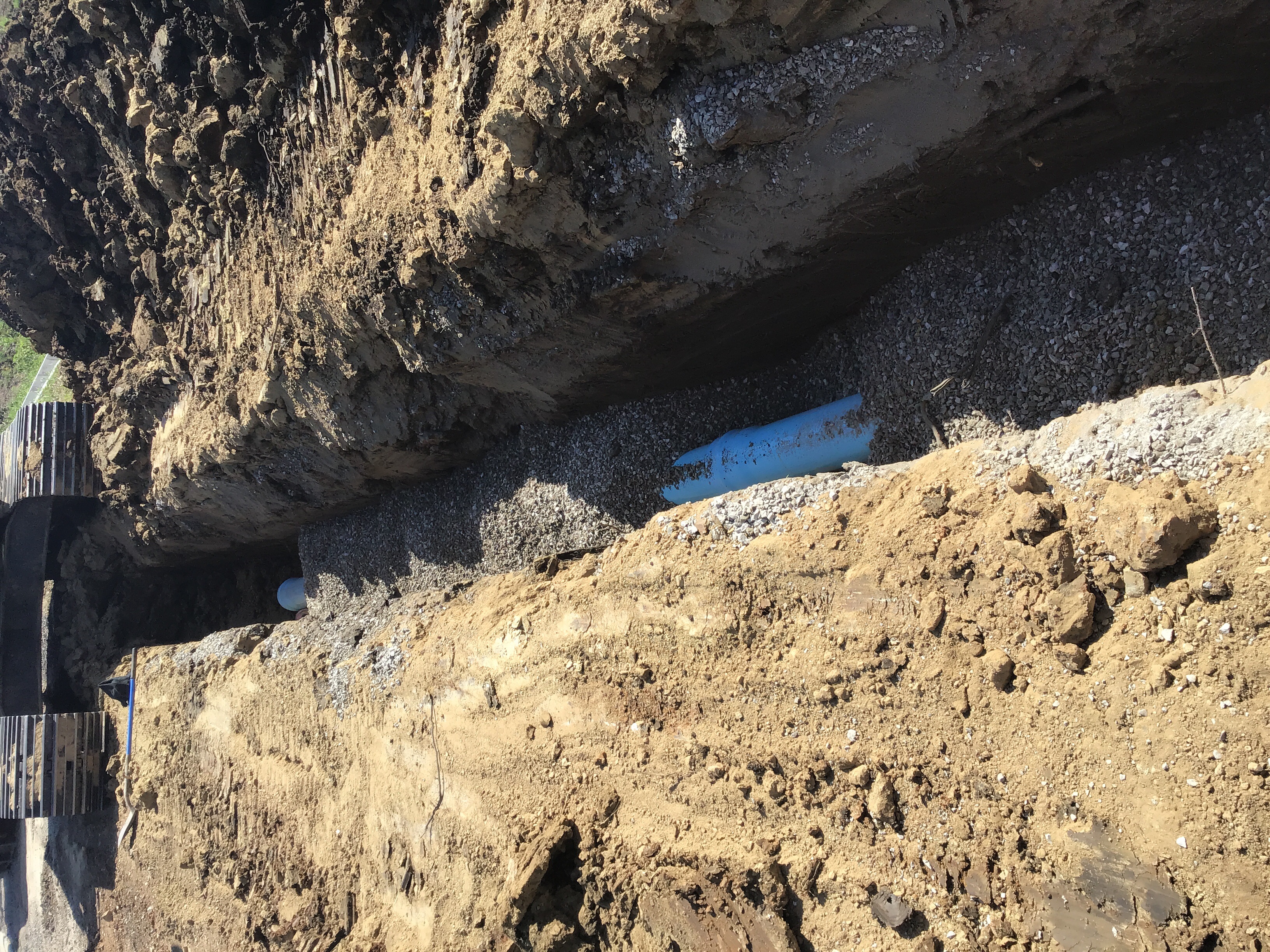

The Redford crew continued the install to approximately station 12+10.42
Water Line - Construction Inspection Partial 7/23/2019 07/23/2019
Misc
Informational
07/19/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/19/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
07/23/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.

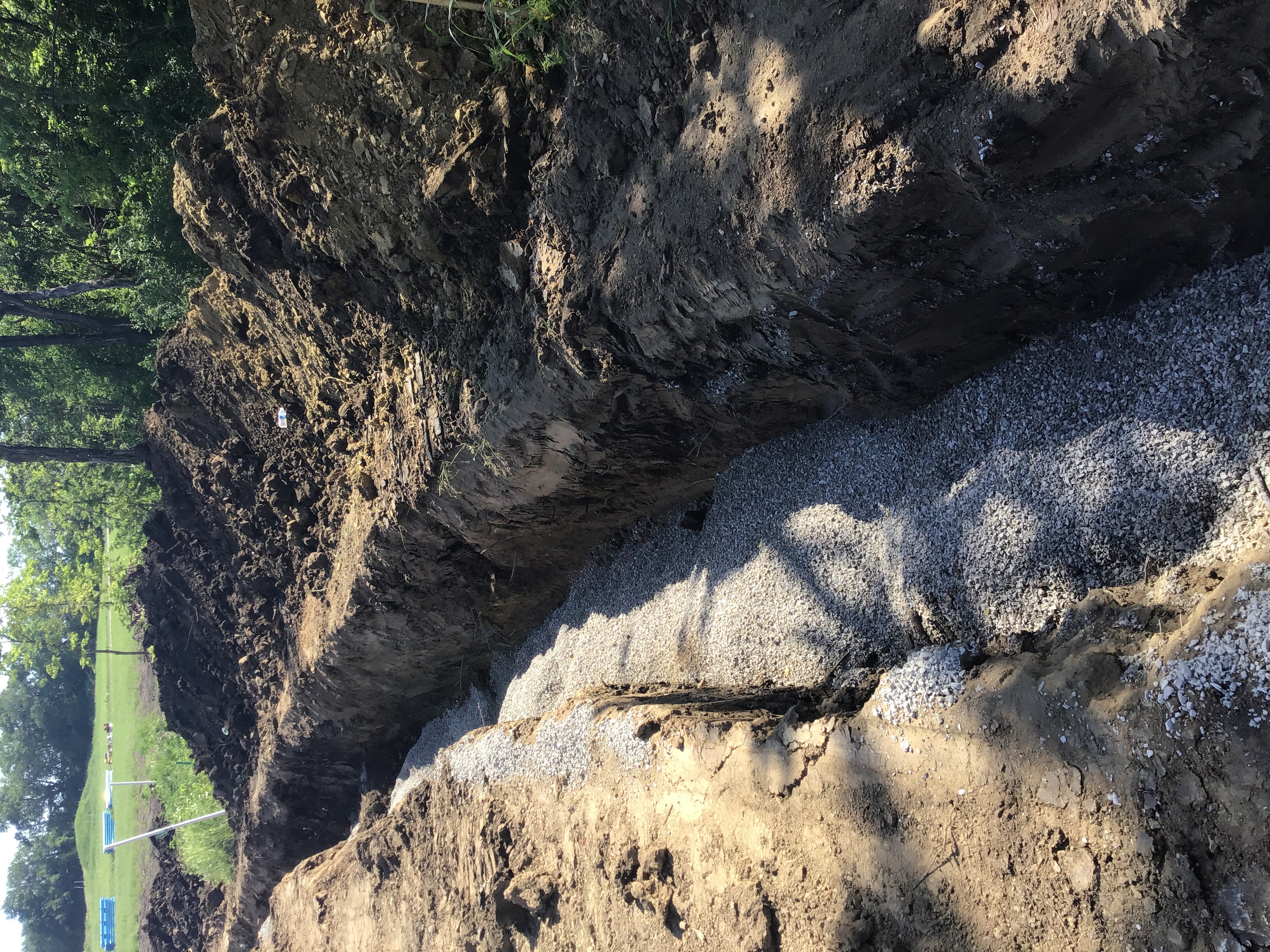

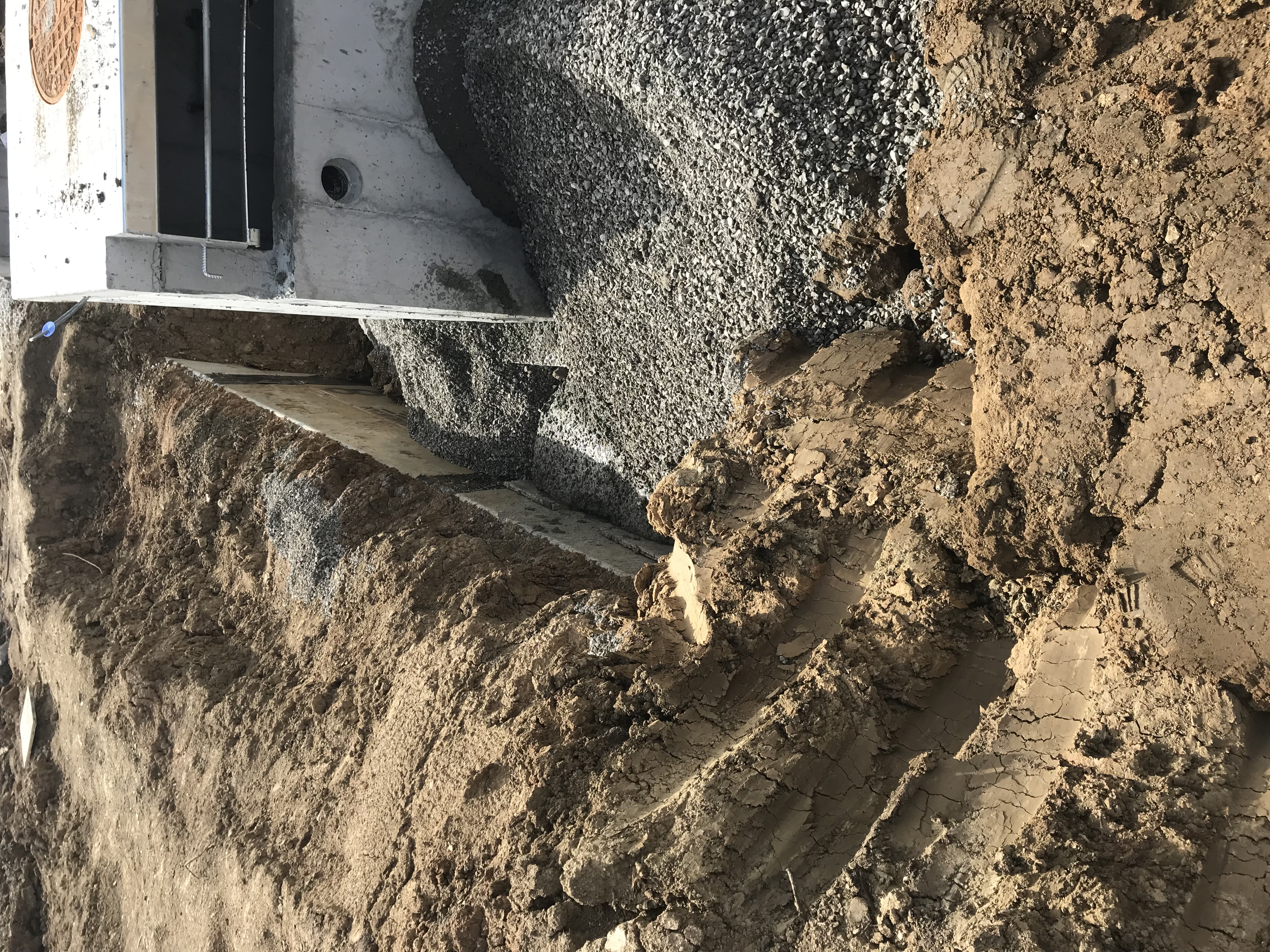

Water Line - Construction Inspection Partial 07/24/2019
Misc
Informational
07/23/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/23/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
07/23/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
07/24/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Water Line - Construction Inspection Partial 07/24/2019
Misc
Informational
07/24/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/24/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
07/24/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
07/24/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
07/24/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Water Line - Construction Inspection Partial 07/26/2019
Misc
Informational
07/24/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/24/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
07/24/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
07/24/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
07/24/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
07/26/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Street - Repairs Passed 8/20/2019 08/20/2019
Misc
Informational
08/20/2019
The Randy Spalding Excavating crew is on site working on the Pryor Rd. West lane install. I verified the correct Geo fabric type and depth of grade. The crew will be working on the lane install for the next few days. Progress photos will uploaded daily.
Erosion Control Inspection Failed 08/27/2019
Misc
Corrective Action Required
04/09/2019
John DiMauro 04/09/2019 3:40 PM I met with David Parks on site to discuss the erosion control issues. I am going to meet with him and his Erosion control contractor on site tomorrow morning to go the corrections needed.
Misc
Corrective Action Required
08/27/2019
Some of the ESC devices on site need to be fixed and maintained following the heavy rain event yesterday. Photos of the failed devices are attached. I talked with the developer Doug Park and he said that Gordon Energy & Drainage was on site yesterday to identify the potential issues and will be out today to make corrections to the failed ESC devices.
Pavement-Proof Roll Failed 09/04/2019
Misc
Corrective Action Required
09/04/2019

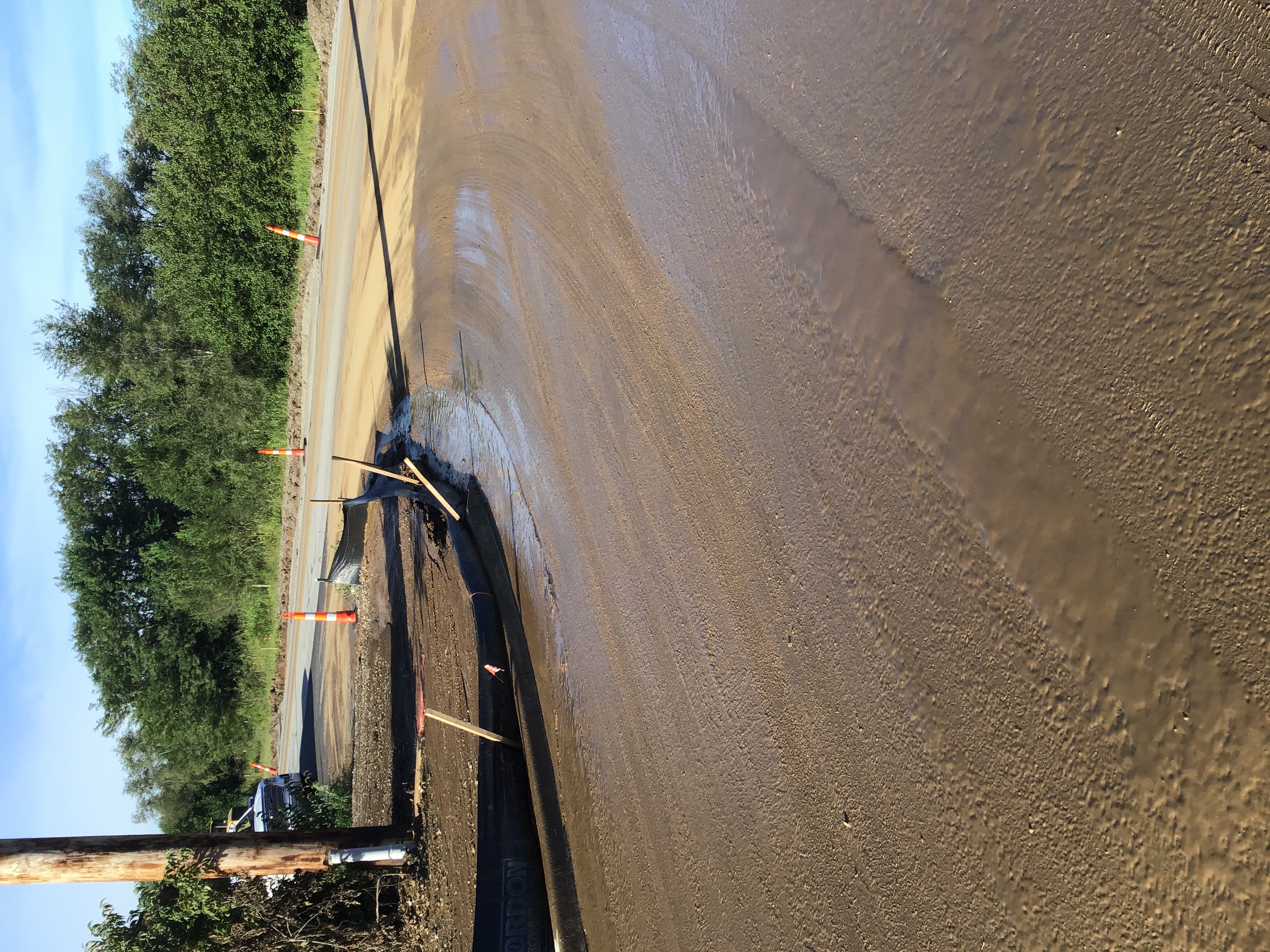

The roll test for the west turn lane on SW Pryor Rd. Failed. There were a few sections of the sub-grade with deflection during the test. The Spalding crew is going to address the soft areas today and set up another proof roll for tomorrow.
Pavement-Proof Roll Passed 9/5/2019 09/05/2019
Misc
Corrective Action Required
09/04/2019
The roll test for the west turn lane on SW Pryor Rd. Failed. There were a few sections of the sub-grade with deflection during the test. The Spalding crew is going to address the soft areas today and set up another proof roll for tomorrow.
Misc
Informational
09/05/2019
The Spalding crew worked on the soft areas yesterday and this morning to prepare for the proof roll. The roll test passed inspection this morning. I verified the correct load weight and equipment used. The paving crew plans to pave the lane tomorrow.
Water Line - Construction Inspection Partial 09/06/2019
Misc
Informational
07/26/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
07/26/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
07/26/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
07/26/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
07/26/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
07/26/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Misc
Informational
09/06/2019
The Redford crew moved over from the off site to work on the on site creek crossing of the waterline. The are preparing the encasement pipe at this time.
Pavement-Surface Partial 09/06/2019
Misc
Informational
09/06/2019
Calverts Paving is on site installing the base lift for the west lane of SW Pryor Rd. I verified the correct asphalt type and temperature and that the correct equipment is being used.
Pavement-Surface Partial 09/06/2019
Misc
Informational
09/06/2019
Calverts Paving is on site installing the base lift for the west lane of SW Pryor Rd. I verified the correct asphalt type and temperature and that the correct equipment is being used.
Misc
Informational
09/06/2019
Calverts Paving is continuing the base asphalt lift. I verified the correct asphalt mix type and temperature. The equipment being used meets the city standards.
Water Line - Construction Inspection Partial 09/09/2019
Misc
Informational
09/06/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
09/06/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
09/06/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
09/06/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
09/06/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
09/06/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Misc
Informational
09/06/2019
The Redford crew moved over from the off site to work on the on site creek crossing of the waterline. The are preparing the encasement pipe at this time.
Misc
Informational
09/09/2019
The Redford Construction crew is working on the creek crossing section of the water line. The crew was breaking rock today and plans to install the line tomorrow.
Water Line - Construction Inspection Partial 09/11/2019
Misc
Informational
09/09/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
09/09/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
09/09/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
09/09/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
09/09/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
09/09/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Misc
Informational
09/09/2019
The Redford crew moved over from the off site to work on the on site creek crossing of the waterline. The are preparing the encasement pipe at this time.
Misc
Informational
09/09/2019
The Redford Construction crew is working on the creek crossing section of the water line. The crew was breaking rock today and plans to install the line tomorrow.
Misc
Informational
09/11/2019
The Redford crew is continuing the the water line install at the creek crossing. The crew encased the pipe that was installed yesterday with concrete and is now making the connections from outside the encasement section. The install appears to match the approved plans and the materials used are accepted. photos of the work have been uploaded to the system.
Water Line - Construction Inspection Partial 09/13/2019
Misc
Informational
09/11/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
09/11/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
09/11/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
09/11/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
09/11/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
09/11/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Misc
Informational
09/11/2019
The Redford crew moved over from the off site to work on the on site creek crossing of the waterline. The are preparing the encasement pipe at this time.
Misc
Informational
09/11/2019
The Redford Construction crew is working on the creek crossing section of the water line. The crew was breaking rock today and plans to install the line tomorrow.
Misc
Informational
09/11/2019
The Redford crew is continuing the the water line install at the creek crossing. The crew encased the pipe that was installed yesterday with concrete and is now making the connections from outside the encasement section. The install appears to match the approved plans and the materials used are accepted. photos of the work have been uploaded to the system.
Misc
Informational
09/13/2019
The Redford crew finished the waterline with concrete encasement through the creek. The concrete was poured and is setting up. The crew plans to backfill on Monday 9/16/19. Photos of the work are uploaded to the system.
Sidewalk Inspection Partial 09/17/2019
Misc
Informational
09/17/2019
PRE POUR INSPECTION The Ray Cochran & Company crew is on site setting up the ADA ramp sections and sidewalks for the for the common areas of the subdivision. The crew is setting up their forms and calling for inspection as they move along. I will continue to inspect the work progress as it goes along and then do a post pour verification inspection when the work is complete.
ADA Inspection Partial 09/17/2019
Misc
Informational
09/17/2019
PRE POUR INSPECTION The Ray Cochran & Company crew is on site setting up the ADA ramp sections and sidewalks for the for the common areas of the subdivision. The crew is setting up their forms and calling for inspection as they move along. I will continue to inspect the work progress as it goes along and then do a post pour verification inspection when the work is complete.
Pavement-Surface Passed 09/17/2019
Misc
Informational
09/06/2019
Calverts Paving is on site installing the base lift for the west lane of SW Pryor Rd. I verified the correct asphalt type and temperature and that the correct equipment is being used.
Misc
Informational
09/06/2019
Calverts Paving is continuing the base asphalt lift. I verified the correct asphalt mix type and temperature. The equipment being used meets the city standards.
Street - Surface Course Passed 09/17/2019
Misc
Informational
09/17/2019
On 9/7/2019 Joe Starlin was on site and inspected the surface asphalt lift install for the west turn lane on SW Pryor Rd. He verified compliance with the city standards. The lane has been striped and appears to match the approved plans and typical detail section.
Street - Wedge Lift Passed 7/16/2019 09/17/2019
Misc
Informational
07/15/2019
The RandySpalding crew is working on the Pryor Rd. right turn lane widening. The crew has the shoulder cut out and to grade. The crew installed geo-grid and base rock. After the base rock cures out we will proof roll prior to paving. Photos are attached.
Misc
Informational
07/15/2019
The crew continued with the Pryor road right turn lane. Additional base rock was installed and the area is cut to grade. Plans are to install asphalt first early next week.
Misc
Informational
07/15/2019
I observed the proof roll for the Pryor Road right turn lane widening. I verified the correct load weight and truck type. Proof roll passed. The Calverts paving crew plans to lay asphalt today.
Misc
Informational
07/15/2019
Calverts Paving installed the base and surface lifts for the Pryor Rd. Right turn lane. I verified proper load and surface temps between lifts and the correct mix types according to the approved plans. The proper equipment is being used.
Sidewalk Inspection Partial 09/18/2019
Misc
Informational
09/17/2019
PRE POUR INSPECTION The Ray Cochran & Company crew is on site setting up the ADA ramp sections and sidewalks for the for the common areas of the subdivision. The crew is setting up their forms and calling for inspection as they move along. I will continue to inspect the work progress as it goes along and then do a post pour verification inspection when the work is complete.
Misc
Informational
09/18/2019
PRE POUR INSPECTION The Ray Cochran & Company crew set up the common area sidewalk. There appears to be sufficient compacted aggregate. I will return for a post pour inspection.
Street - Repairs Passed 8/21/2019 09/19/2019
Site Visit Failed - Stop Work 11/5/2019 11/05/2019
Miscellaneous Correction
Corrective Action Required
11/05/2019
John DiMauro took a Stop Work/Construction sign out to the site to post it. The contractors can begin work again after the temporary crossing has been removed from the creek.
Water Line - Construction Inspection Partial 11/12/2019
Misc
Informational
09/13/2019
The Redford Construction crew is on site installing the Public water main. I inspected approximately 200’ ft of the line they have laid from station 6+52.37 to about 8+50. The crew installed the 90 degree bend at the road crossing and the gate valve at station 6+62.37 Photos are attached.
Misc
Informational
09/13/2019
The Redford crew continued the install to approximately station 12+10.42
Misc
Informational
09/13/2019
The Redford Crew is continuing the Water Line A install. Photos are the current progress are attached and I will return for further inspection today.
Misc
Informational
09/13/2019
The Redford Construction crew is on site installing water line C. The install appears to match the plans and the materials used are correct. I will return for further inspections this afternoon.
Misc
Informational
09/13/2019
The Redford Construction crew installed water line C today. I verified that the install matched the approved plans and that the materials used meet the city standards. The crew is now Continuing the install of public water line A. The crew has the line installed from approx station 15+10.40 to 17+34.29 I verified correct materials used and that the install matches the plans and meets the city standards. Photos are attached to the permit.
Misc
Informational
09/13/2019
The Redford crew is working on the water line A install. The crew has the line ran from approx 17+34.29 to station 19+19.27 I inspected the Thrust blocks and restraints poured yesterday on water lines A & C. The install appears to meet the city standards. Photos are attached to the permit.
Misc
Informational
09/13/2019
The Redford crew moved over from the off site to work on the on site creek crossing of the waterline. The are preparing the encasement pipe at this time.
Misc
Informational
09/13/2019
The Redford Construction crew is working on the creek crossing section of the water line. The crew was breaking rock today and plans to install the line tomorrow.
Misc
Informational
09/13/2019
The Redford crew is continuing the the water line install at the creek crossing. The crew encased the pipe that was installed yesterday with concrete and is now making the connections from outside the encasement section. The install appears to match the approved plans and the materials used are accepted. photos of the work have been uploaded to the system.
Misc
Informational
09/13/2019
The Redford crew finished the waterline with concrete encasement through the creek. The concrete was poured and is setting up. The crew plans to backfill on Monday 9/16/19. Photos of the work are uploaded to the system.
Misc
Informational
11/12/2019
The Redford crew tied in the new 8” water main to the existing 16” main for the subdivision. I verified the correct materials used and that the install matches the approved plans. Photos of the install are uploaded.
Water Line - Construction Inspection Passed 11/18/2019
Misc
Informational
11/18/2019
On Friday 11/15/2019 The Redford crew and the City of LS Water Utilities crew installed the construction taps for the water line. A hydrostatic pressure test was performed and passed. The crew chlorinated the line and it sat over the weekend. I verified the correct chlorine residue was put in the line. The crew is on site now flushing the line to prepare for the bacteria testing tomorrow. I verified that the flush complies with the city of LS standards.
Water Line - Hydrostatic Test Passed 11/18/2019
Misc
Informational
11/18/2019
On Friday 11/15/2019 the Redford crew performed the Hydro test on the water system. I observed the line hold at 150 PSI for two hours. The test passed.
Water Line - Coliform Test 1 Failed 11/21/2019 11/21/2019
Misc
Corrective Action Required
11/21/2019
We collected the day 1 water samples for bacteria testing on Tuesday 11/19/19 and delivered them to Keystone Labs. Test spot 2 of the samples failed for total coliforms. We will now repeat the sampling process.
Water Line - Construction Inspection Partial 11/24/2019 11/24/2019
Misc
Informational
11/24/2019
John DiMauro 11/24/2019 2:31 PM I met with the Redford crew to flush the water line to prepare for round 2 of water samples on the water line. We will pull a day 1 sample tomorrow.
Water Line - Coliform Test 1 Partial 11/25/2019 11/25/2019
Misc
Corrective Action Required
11/21/2019
We collected the day 1 water samples for bacteria testing on Tuesday 11/19/19 and delivered them to Keystone Labs. Test spot 2 of the samples failed for total coliforms. We will now repeat the sampling process.
Misc
Informational
11/25/2019
John DiMauro 11/25/2019 11:28 AM The original day 1 samples failed for Total Coliform. I met with the Redford crew yesterday and flushed the water line. The crew collected a new round of day 1 samples this morning and I delivered them to Keystone Labs. We will know the results in 24 hours.
Water Line - Coliform Test 2 Partial 11/26/2019 11/26/2019
Misc
Informational
11/26/2019
We collected the day 2 water samples and delivered them to Keystone Labs for testing. We will know the results in 24 hours.
Master Drainage As-built Inspection Passed 12/3/2019 12/02/2019
Erosion Control Inspection Failed 12/30/2019
Misc
Corrective Action Required
08/27/2019
John DiMauro 04/09/2019 3:40 PM I met with David Parks on site to discuss the erosion control issues. I am going to meet with him and his Erosion control contractor on site tomorrow morning to go the corrections needed.
Misc
Corrective Action Required
08/27/2019
Some of the ESC devices on site need to be fixed and maintained following the heavy rain event yesterday. Photos of the failed devices are attached. I talked with the developer Doug Park and he said that Gordon Energy & Drainage was on site yesterday to identify the potential issues and will be out today to make corrections to the failed ESC devices.
Misc
Corrective Action Required
12/30/2019
EROSION CONTROL INSPECTION FAILED. THERE ARE A NUMBER OF AREAS WHERE THE SILT FENCE HAS FAILED. MUD AND SILT IS WASHING OUT ON THE ROADWAY AND INTO THE STORM WATER COLLECTION SYSTEM. MAKE CORRECTIONS TO THE DEVICES AND CLEAN THE MUD AND SILT FROM THE ROAD AND STORM INLETS.
Erosion Control Inspection Passed 01/02/2020
Misc
Corrective Action Required
12/30/2019
John DiMauro 04/09/2019 3:40 PM I met with David Parks on site to discuss the erosion control issues. I am going to meet with him and his Erosion control contractor on site tomorrow morning to go the corrections needed.
Misc
Corrective Action Required
12/30/2019
Some of the ESC devices on site need to be fixed and maintained following the heavy rain event yesterday. Photos of the failed devices are attached. I talked with the developer Doug Park and he said that Gordon Energy & Drainage was on site yesterday to identify the potential issues and will be out today to make corrections to the failed ESC devices.
Misc
Corrective Action Required
12/30/2019
EROSION CONTROL INSPECTION FAILED. THERE ARE A NUMBER OF AREAS WHERE THE SILT FENCE HAS FAILED. MUD AND SILT IS WASHING OUT ON THE ROADWAY AND INTO THE STORM WATER COLLECTION SYSTEM. MAKE CORRECTIONS TO THE DEVICES AND CLEAN THE MUD AND SILT FROM THE ROAD AND STORM INLETS.
Misc
Resolved
01/02/2020
The erosion control devices were restored and the mud and silt was cleaned from the road.
Erosion Control Inspection Failed 03/09/2020
Misc
Corrective Action Required
03/09/2020
EROSION CONTROL INSPECTION FAILD. There are areas around the basin where the silt fence is down and is allowing silt to run and collect into the basin. The area around the creek needs to be graded and protected from site runoff. There is an area near the entrance of the site that needs erosion control devices installed to protect the creek. Steve Robbins and I met with the developer Doug Park to discuss the erosion control issues on Friday 3/6/2020. Doug said that he will get the areas noted protected and cleaned up asap.
Erosion Control Inspection Failed 03/27/2020
Misc
Corrective Action Required
03/09/2020
EROSION CONTROL INSPECTION FAILD. There are areas around the basin where the silt fence is down and is allowing silt to run and collect into the basin. The area around the creek needs to be graded and protected from site runoff. There is an area near the entrance of the site that needs erosion control devices installed to protect the creek. Steve Robbins and I met with the developer Doug Park to discuss the erosion control issues on Friday 3/6/2020. Doug said that he will get the areas noted protected and cleaned up asap.
Miscellaneous Correction
Corrective Action Required
03/27/2020
EROSION CONTROL INSPECTION FAILD. There are areas around the basin where the silt fence is down and is allowing silt to run and collect into the basin. The area around the creek needs to be graded and protected from site runoff. There is an area near the entrance of the site that needs erosion control devices installed to protect the creek. At the entrance of SW Pryor RD and SW River Run DR the silt fence has failed and is allowing silt and mud to collect on the street. Make corrections to the fence and clean the street asap.
Erosion Control Inspection Partial 04/02/2020
Misc
Resolved
04/02/2020
EROSION CONTROL INSPECTION FAILD. There are areas around the basin where the silt fence is down and is allowing silt to run and collect into the basin. The area around the creek needs to be graded and protected from site runoff. There is an area near the entrance of the site that needs erosion control devices installed to protect the creek. Steve Robbins and I met with the developer Doug Park to discuss the erosion control issues on Friday 3/6/2020. Doug said that he will get the areas noted protected and cleaned up asap.
Miscellaneous Correction
Resolved
04/02/2020
EROSION CONTROL INSPECTION FAILD. There are areas around the basin where the silt fence is down and is allowing silt to run and collect into the basin. The area around the creek needs to be graded and protected from site runoff. There is an area near the entrance of the site that needs erosion control devices installed to protect the creek. At the entrance of SW Pryor RD and SW River Run DR the silt fence has failed and is allowing silt and mud to collect on the street. Make corrections to the fence and clean the street asap.
Misc
Informational
04/02/2020

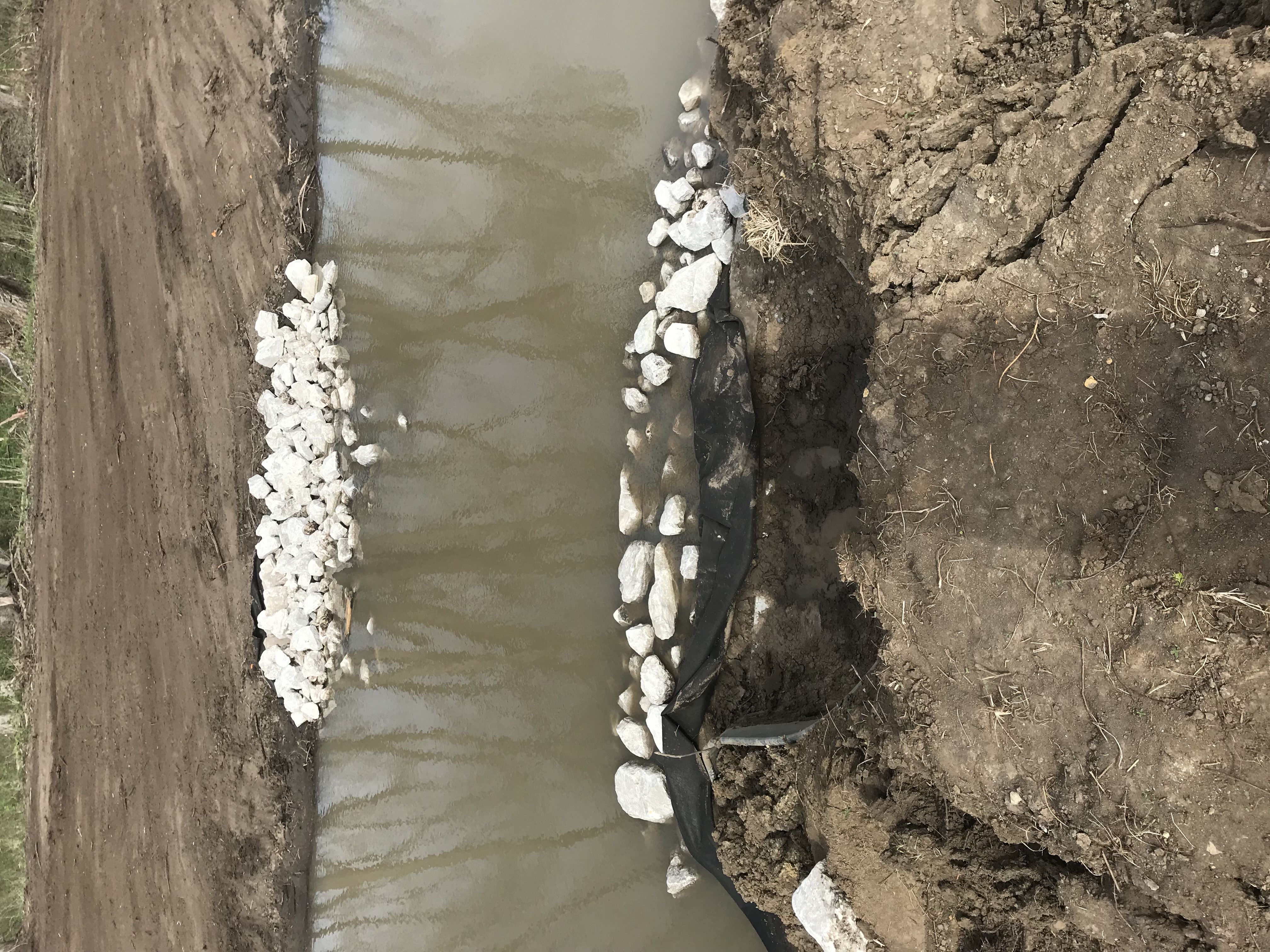

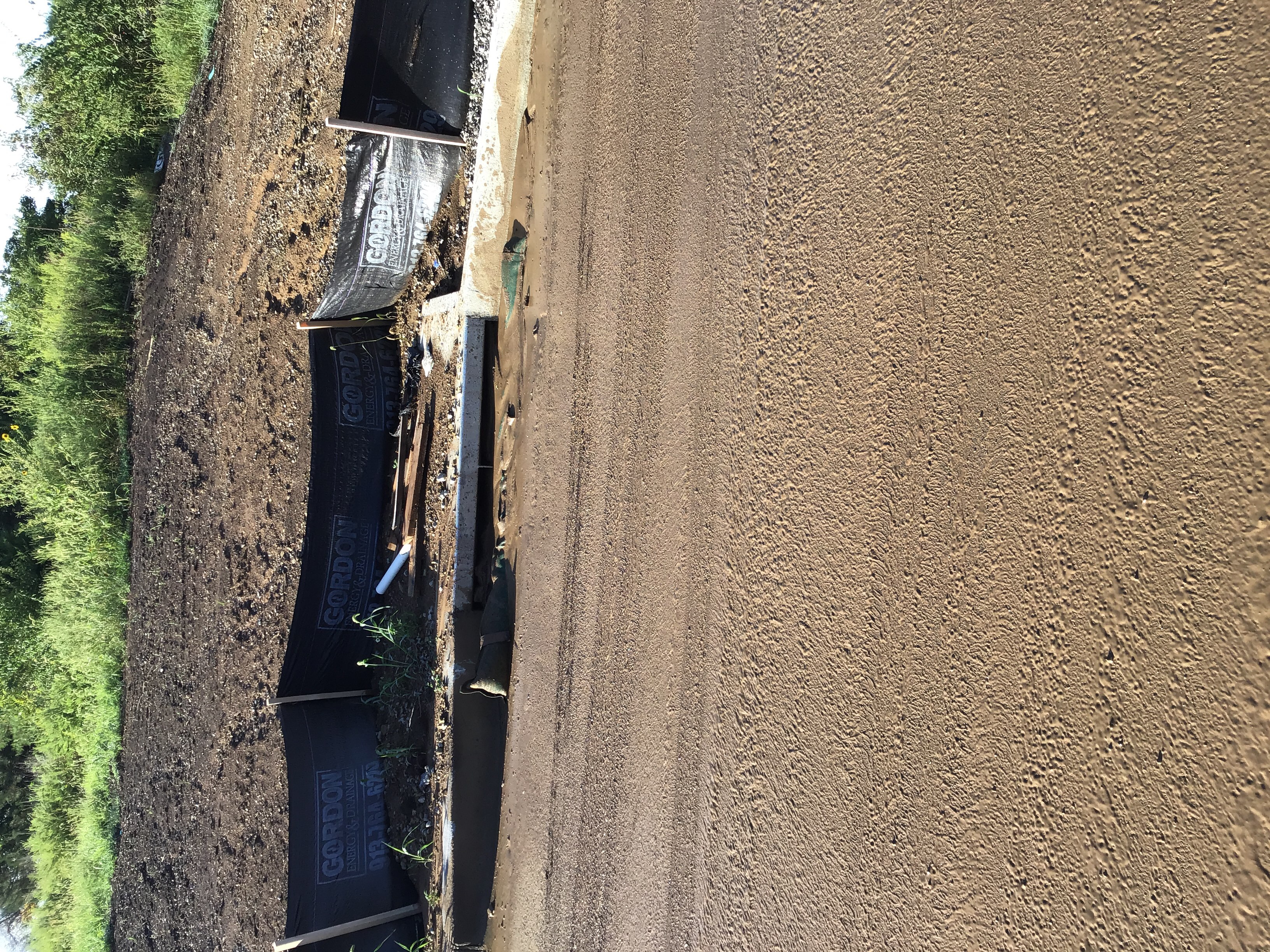

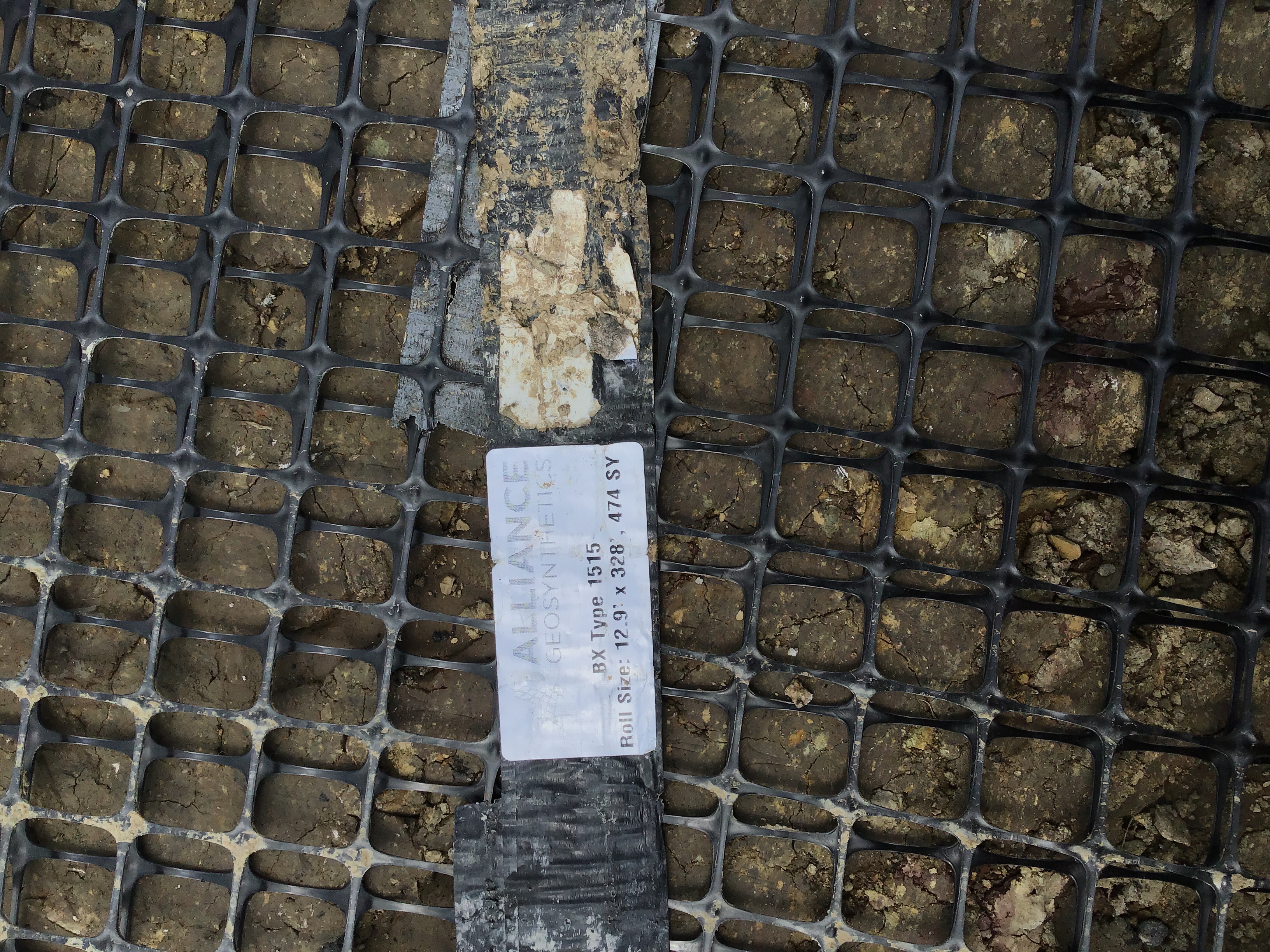

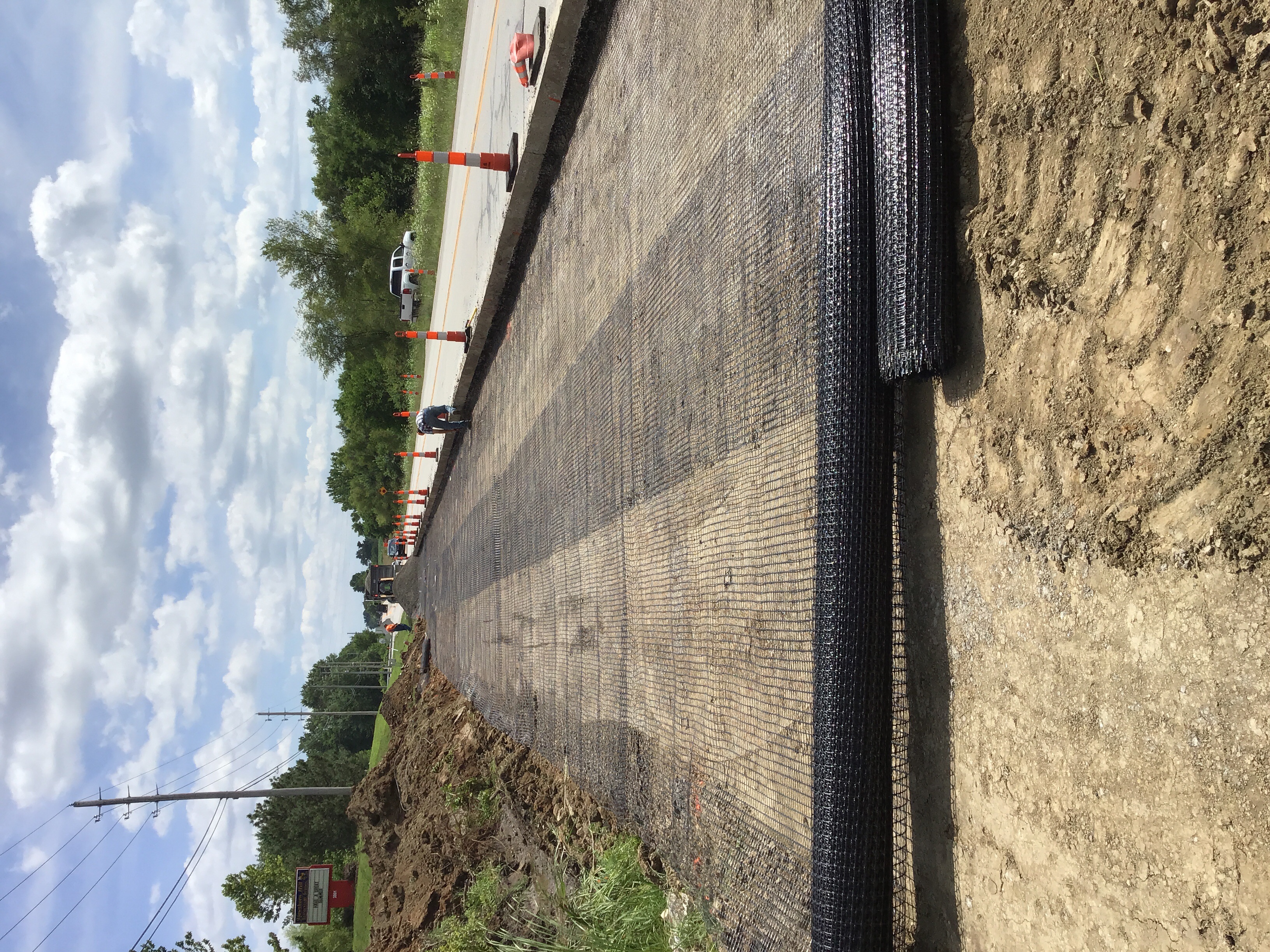

Developer Doug Park has a crew on site installing erosion matting along the entrance and around the box culvert surrounding the creek. The crew graded these areas down to final grade and has installed seed and erosion matting. The crew also graded along the creek and pond to help with the erosion issues there. They removed the silt build up from the pond. Gordon energy is scheduled to be on site to fix all the areas of silt fence that have failed along with the inlet protection that needs addressed.
Pavement-Curb Construction Partial 05/19/2020
Misc
Informational
05/19/2020
Bob Cochran Concrete is on site replacing the sections of curb that were cracked and damaged. Public works bond inspection discovered sections of curb to be replaced and the crew is on site now. Pre pour inspection was performed and the sub grade and forms are set for the install. I will return for further inspection.
Erosion Control Inspection Failed 05/26/2020
Misc
Resolved
05/26/2020
Developer Doug Park has a crew on site installing erosion matting along the entrance and around the box culvert surrounding the creek. The crew graded these areas down to final grade and has installed seed and erosion matting. The crew also graded along the creek and pond to help with the erosion issues there. They removed the silt build up from the pond. Gordon energy is scheduled to be on site to fix all the areas of silt fence that have failed along with the inlet protection that needs addressed.
Misc
Corrective Action Required
05/26/2020
There are areas on site where the silt fence has failed and needs replaced. Curb inlet protection devices need cleaned and maintained. Streets need cleaned of mud and debris.
Miscellaneous PWORKS Inspection Failed 6/17/2021 06/17/2021
Miscellaneous Correction
Corrective Action Required
06/17/2021
I have sent Doug Park, the developer an email asking that we receive the remain ding maintenance bonds for the curb and the pavement. I also asked that the erosion control be cleaned up in the subdivision. I let him know we would be stopping permits and building inspections if we did not get the punch list taken care of.
Miscellaneous PWORKS Inspection Failed 6/18/2021 06/18/2021
Miscellaneous Correction
Corrective Action Required
06/17/2021
I have sent Doug Park, the developer an email asking that we receive the remain ding maintenance bonds for the curb and the pavement. I also asked that the erosion control be cleaned up in the subdivision. I let him know we would be stopping permits and building inspections if we did not get the punch list taken care of.
Misc
Corrective Action Required
06/18/2021
I called Doug Park this morning and left a VM for him to call me back about the punch list items and erosion control issues for Whispering Woods 1st Plat.
Documents & Images
Date Uploaded File Type Document Name
07/23/2018 Receipt Receipt for transaction: 2018-005085
07/25/2018 Letter DE-Permit
07/26/2018 Letter DE-Daily Inspection Summary
08/01/2018 Letter DE-Daily Inspection Summary
08/07/2018 Letter DE-Daily Inspection Summary
08/09/2018 Letter DE-Daily Inspection Summary
08/13/2018 Letter DE-Daily Inspection Summary
08/16/2018 Letter DE-Daily Inspection Summary
08/27/2018 Letter DE-Daily Inspection Summary
08/30/2018 Letter DE-Daily Inspection Summary
09/05/2018 Letter DE-Daily Inspection Summary
09/19/2018 Letter DE-Daily Inspection Summary
09/21/2018 Letter DE-Daily Inspection Summary
09/25/2018 Letter DE-Daily Inspection Summary
10/02/2018 Letter DE-Daily Inspection Summary
10/04/2018 Letter DE-Daily Inspection Summary
10/04/2018 Receipt Receipt for transaction: 2018-006700
10/17/2018 Letter DE-Daily Inspection Summary
10/19/2018 Letter DE-Daily Inspection Summary
10/30/2018 image
10/30/2018 image0
10/30/2018 image1
10/30/2018 Letter Inspection Summary
10/31/2018 image2
10/31/2018 image3
10/31/2018 image4
10/31/2018 Letter Inspection Summary
11/01/2018 image5
11/01/2018 Letter Inspection Summary
11/08/2018 Letter DE-Daily Inspection Summary
11/12/2018 Letter Inspection Summary
11/27/2018 Letter DE-Daily Inspection Summary
11/28/2018 Letter DE-Daily Inspection Summary
11/30/2018 DOC113018-11302018104344
03/29/2019 Receipt Receipt for transaction: 2019-001143
04/09/2019 Letter DE-Daily Inspection Summary
04/10/2019 image6
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter INSPECTION SUMMARY
04/10/2019 Letter INSPECTION SUMMARY
04/11/2019 Letter DE-Daily Inspection Summary
04/11/2019 Basin Riprap 1
04/11/2019 Basin Riprap 2
04/11/2019 Basin Riprap 3
04/11/2019 Basin Riprap 4
04/11/2019 Basin Riprap 5
04/11/2019 Letter DE-Daily Inspection Summary
04/11/2019 IMG_1498
04/11/2019 IMG_1499
04/11/2019 IMG_1500
04/11/2019 IMG_1501
04/11/2019 IMG_1502
04/11/2019 IMG_1503
04/22/2019 Letter INSPECTION SUMMARY
04/22/2019 Letter INSPECTION SUMMARY
04/22/2019 Letter INSPECTION SUMMARY
04/22/2019 image7
05/17/2019 Letter INSPECTION SUMMARY
05/17/2019 Letter INSPECTION SUMMARY
05/17/2019 Letter DE-Daily Inspection Summary
05/17/2019 Letter INSPECTION SUMMARY
06/04/2019 Letter INSPECTION SUMMARY
06/10/2019 Letter INSPECTION SUMMARY

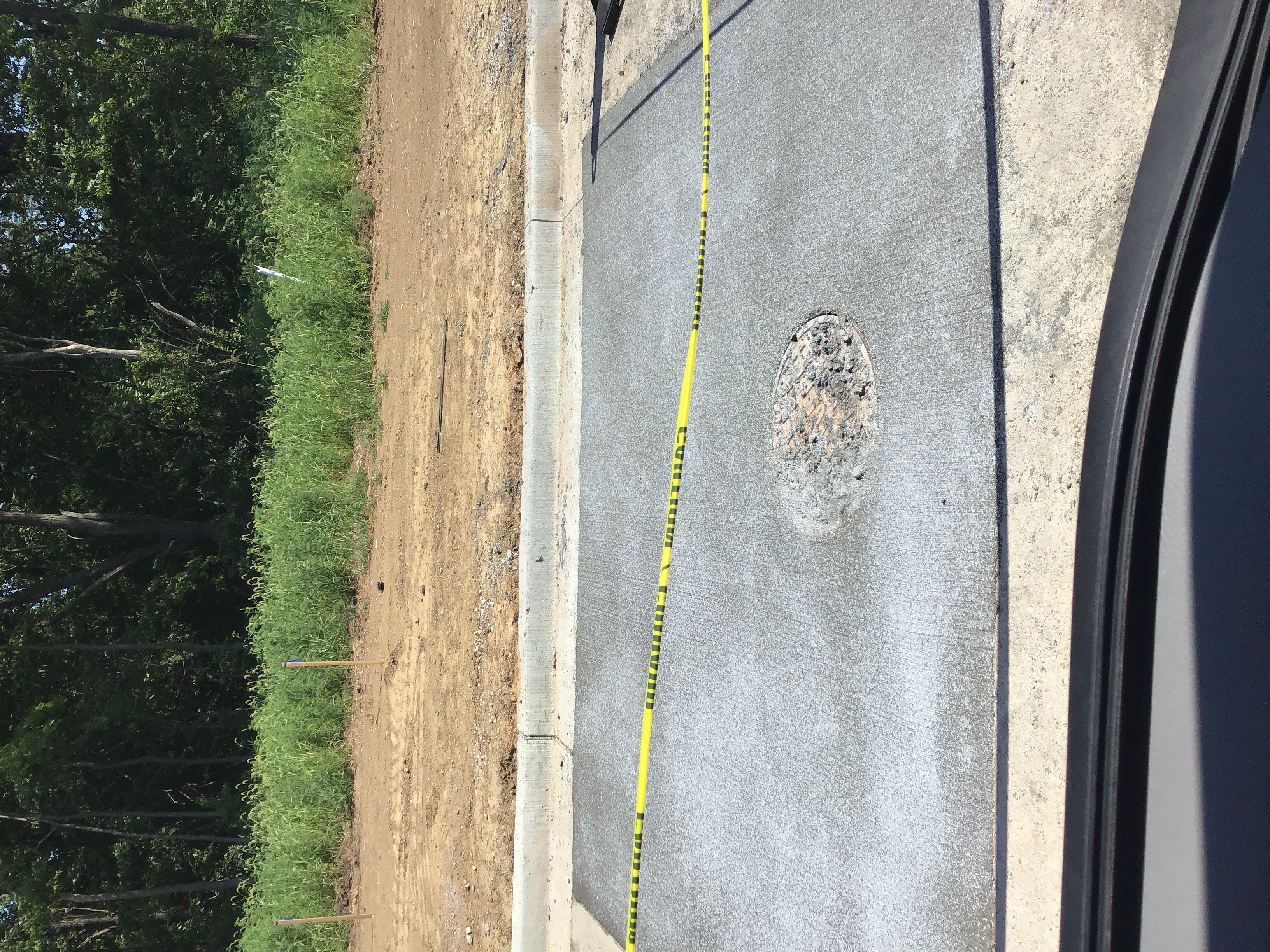

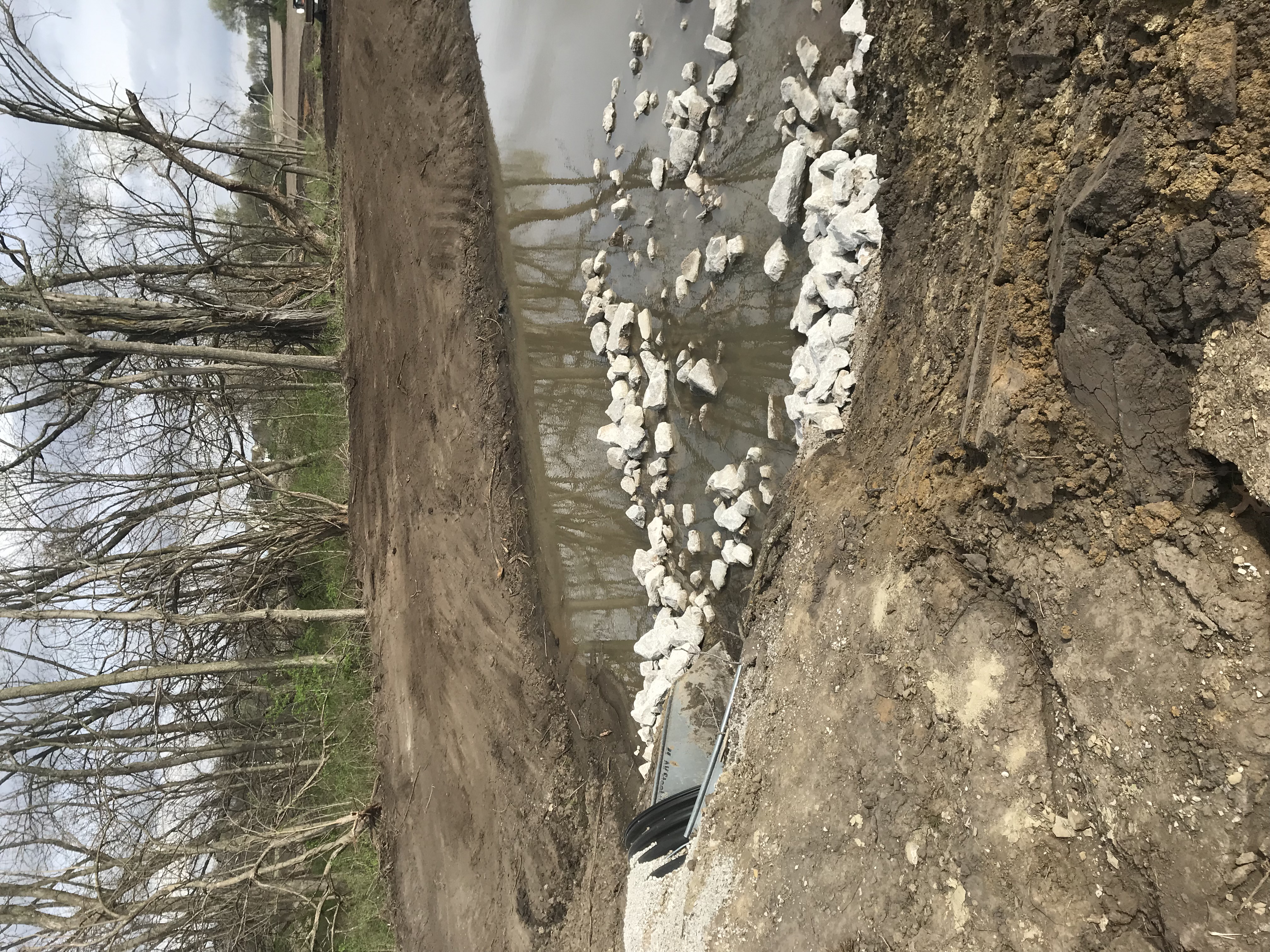

06/13/2019 Curb
06/13/2019 Curb0
06/13/2019 Curb1
06/13/2019 Curb2
06/13/2019 Curb3
06/13/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter INSPECTION SUMMARY
06/17/2019 Letter INSPECTION SUMMARY
06/20/2019 Letter INSPECTION SUMMARY
07/09/2019 Letter INSPECTION SUMMARY
07/09/2019 Letter INSPECTION SUMMARY
07/10/2019 Letter INSPECTION SUMMARY

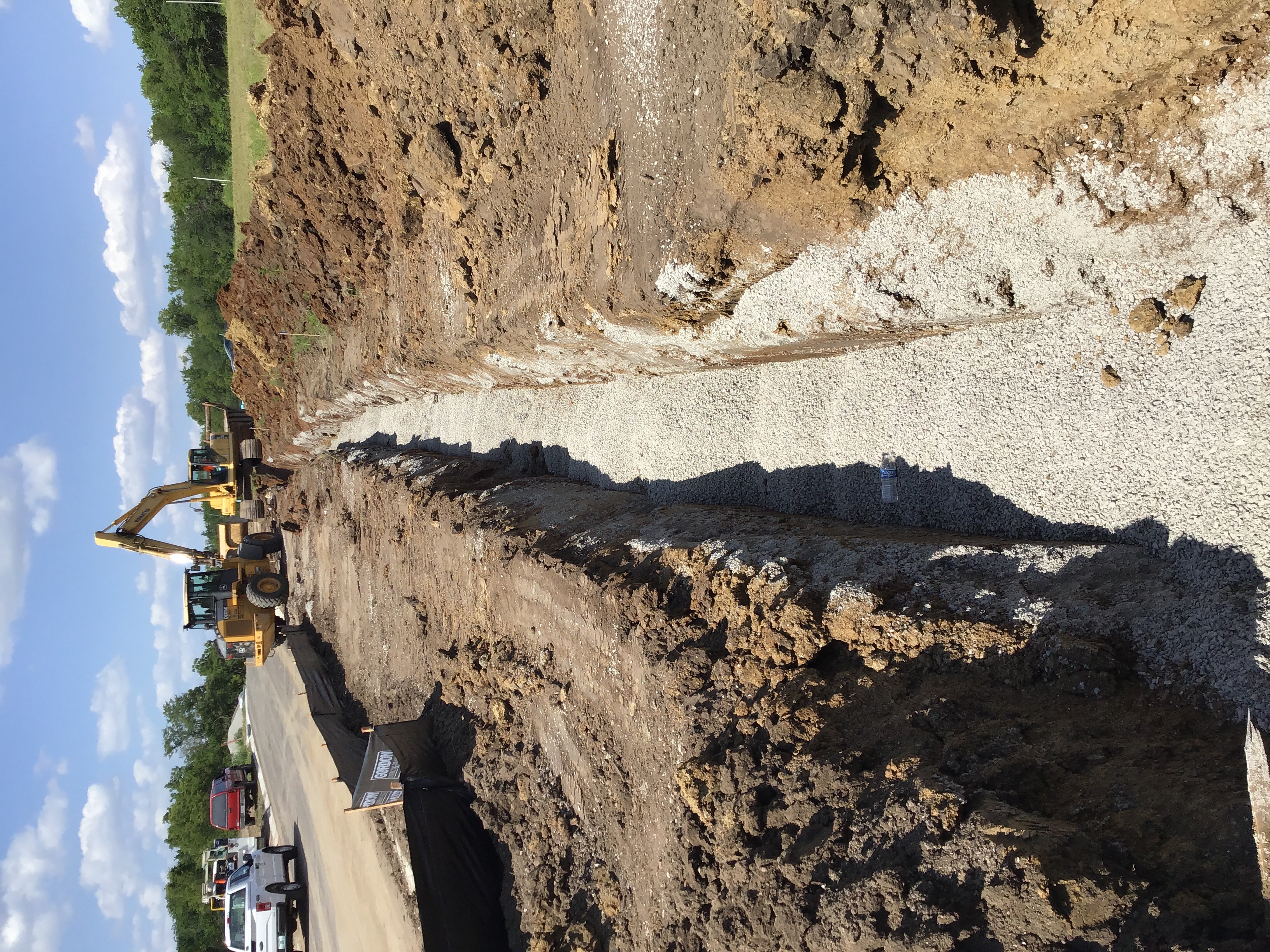

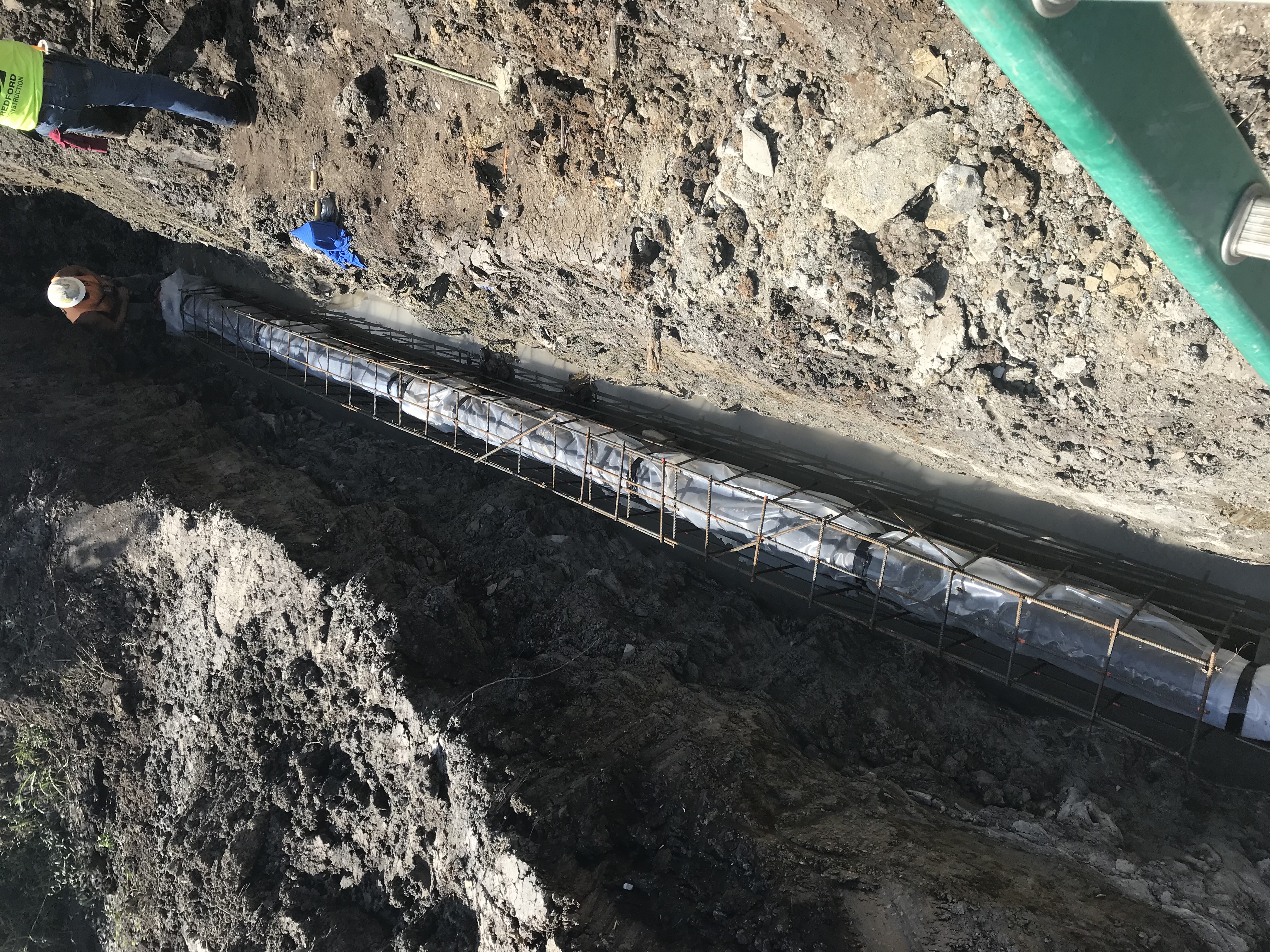

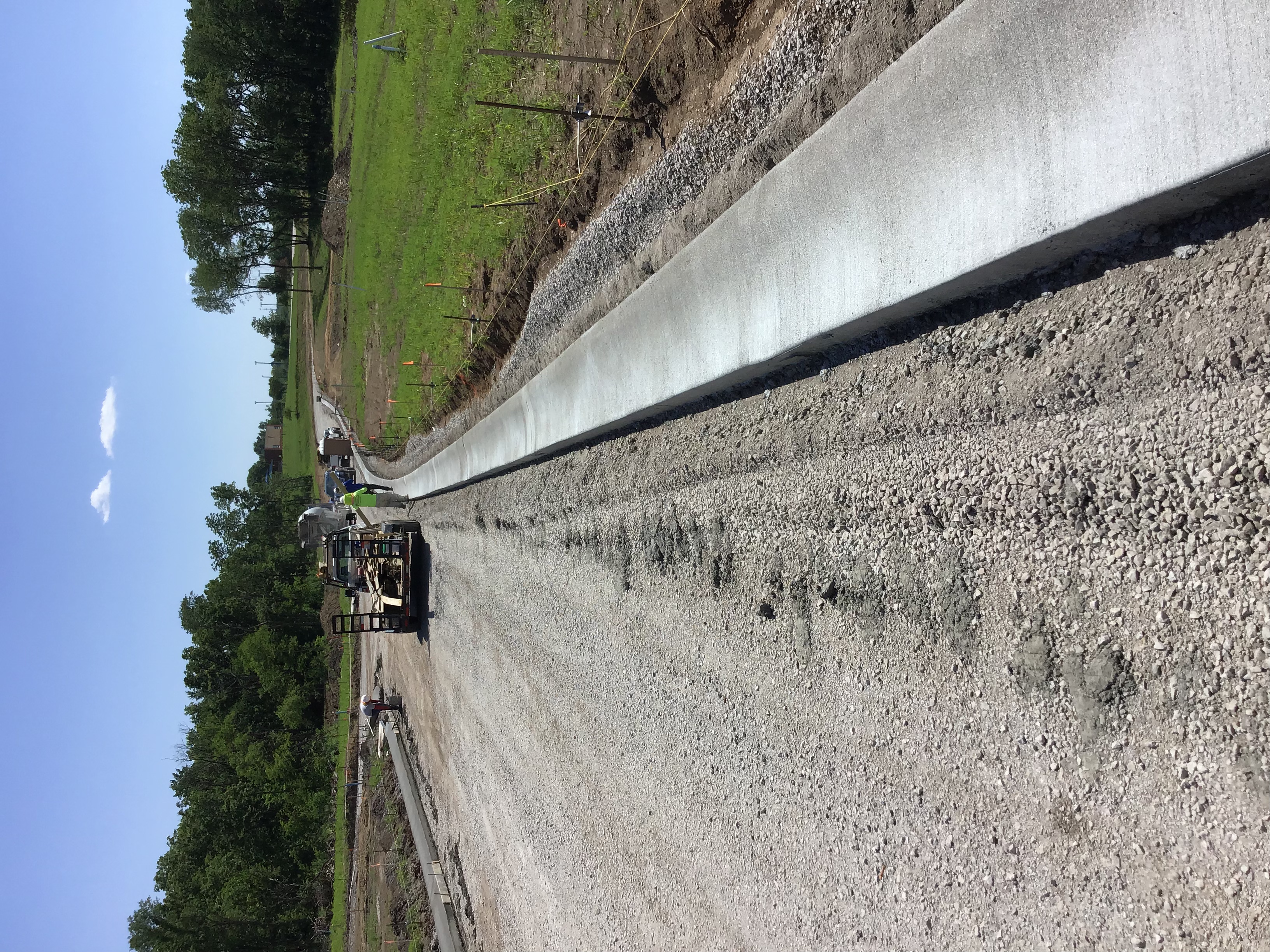

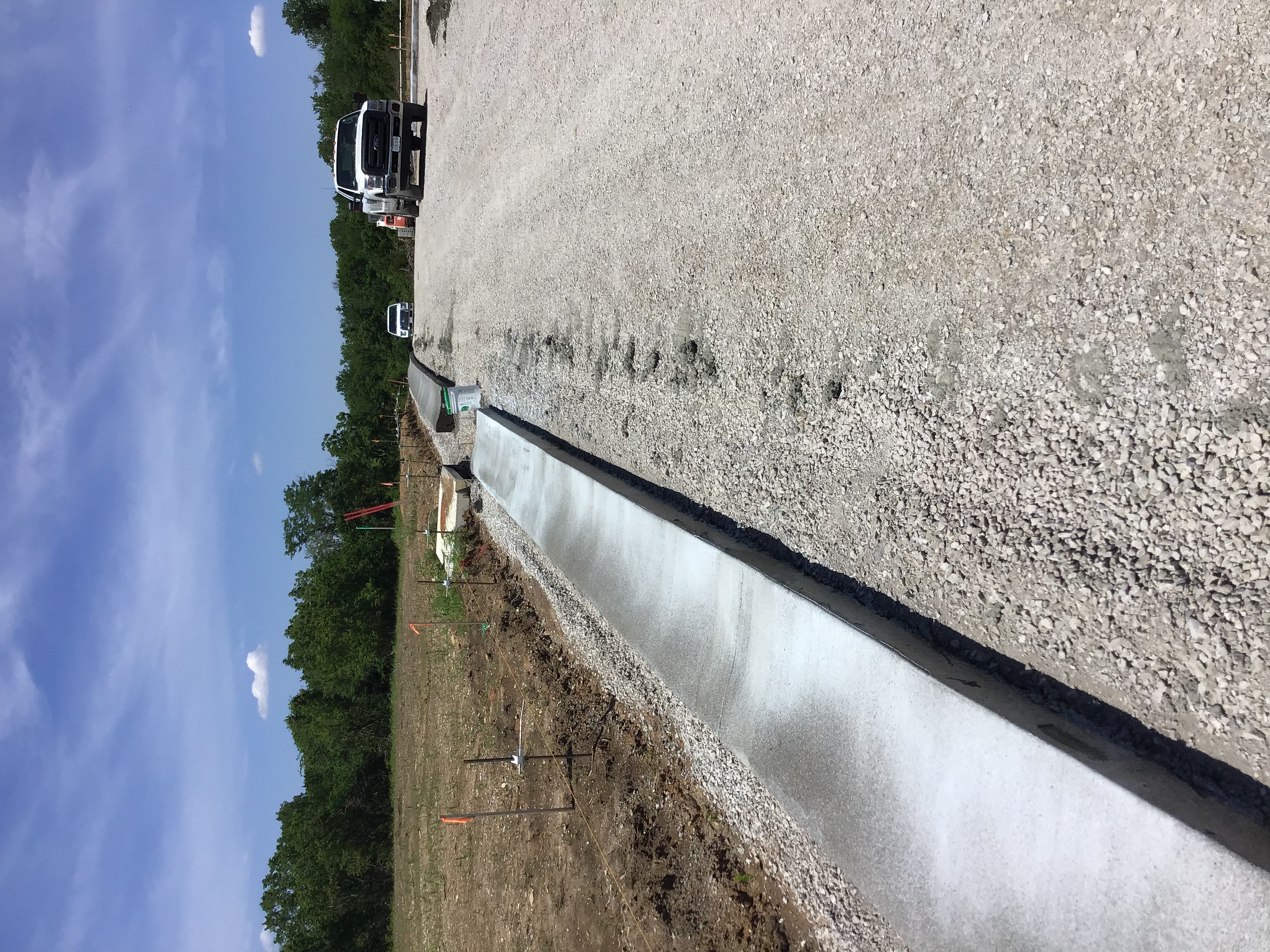

07/11/2019 Pryor road right turn lane subgrade
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/11/2019 Letter INSPECTION SUMMARY
07/12/2019 Letter INSPECTION SUMMARY
07/12/2019 Letter INSPECTION SUMMARY
07/15/2019 Letter INSPECTION SUMMARY
07/15/2019 Pryor Rd turn lane
07/15/2019 Pryor Rd turn lane 2
07/15/2019 Letter INSPECTION SUMMARY

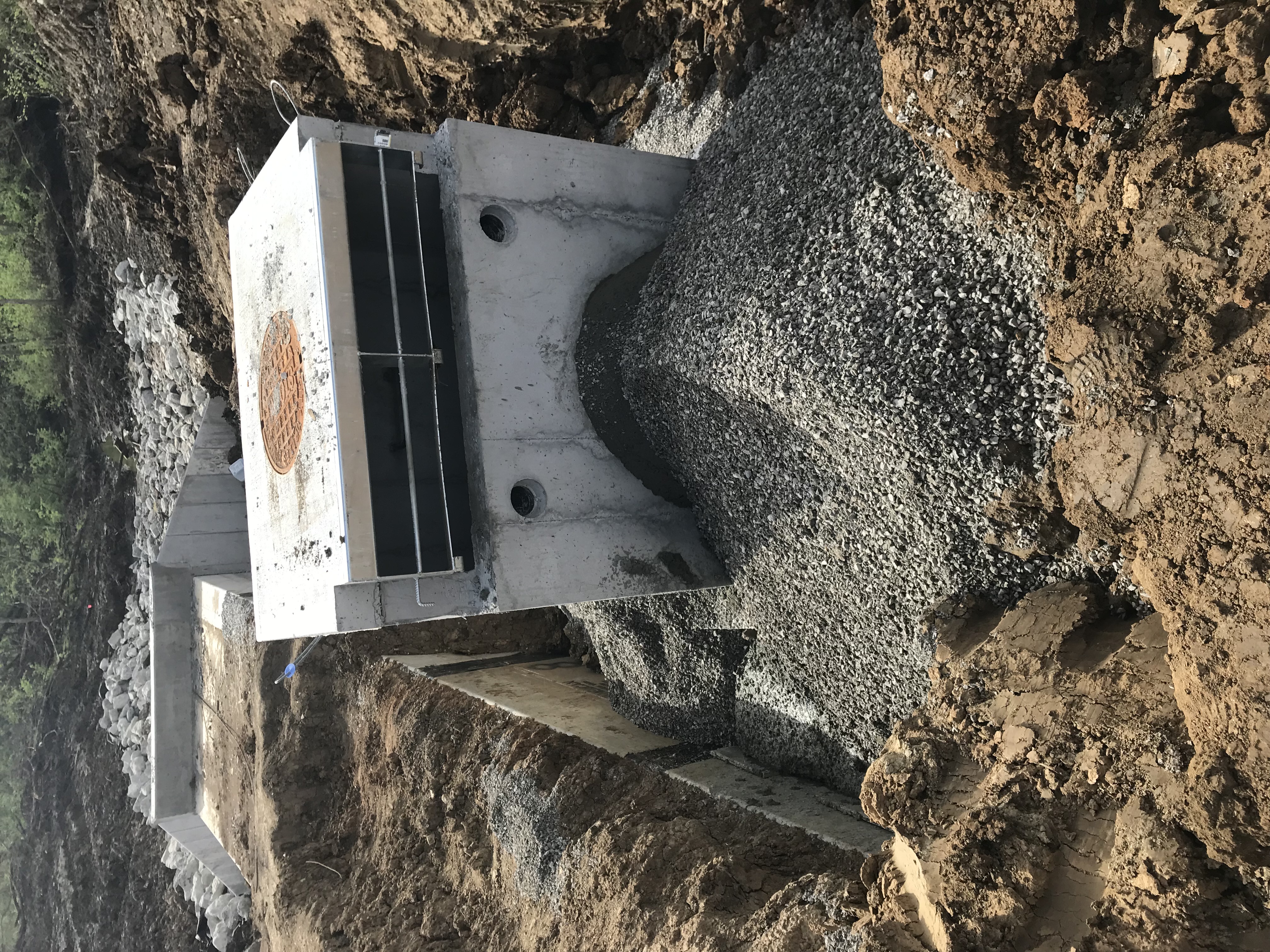

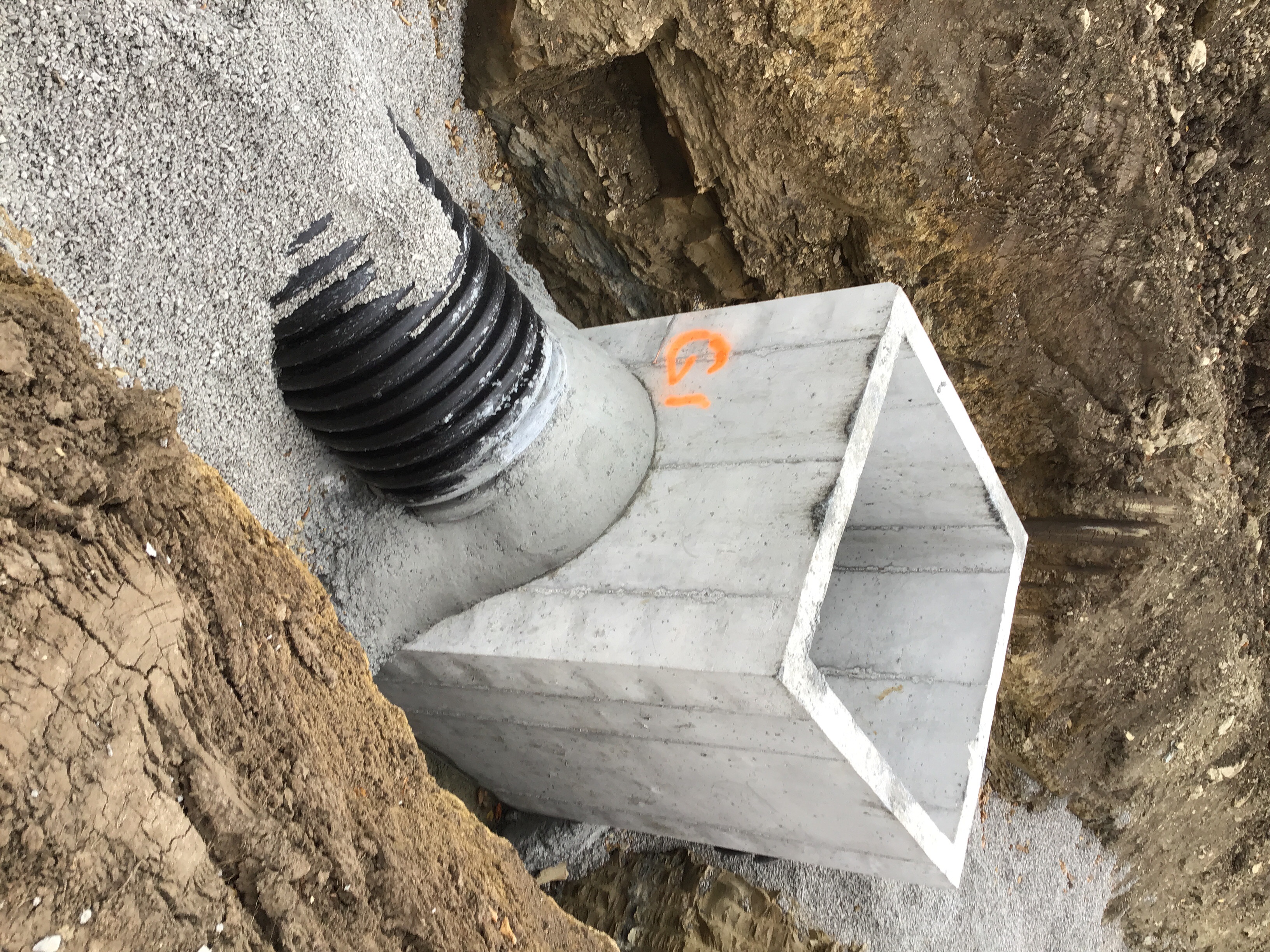

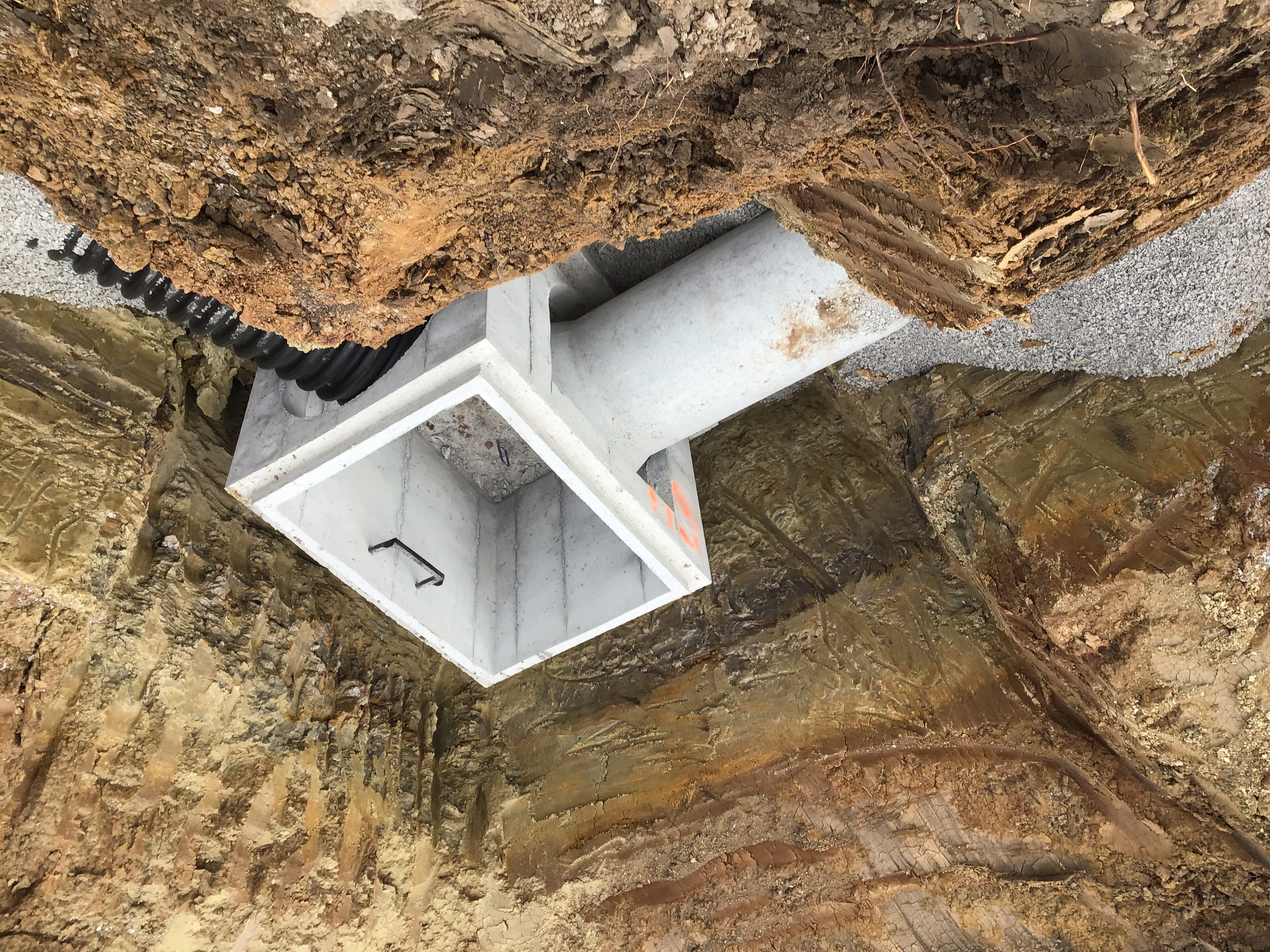

07/18/2019 Street manhole
07/18/2019 Street manhole 2
07/18/2019 Letter INSPECTION SUMMARY

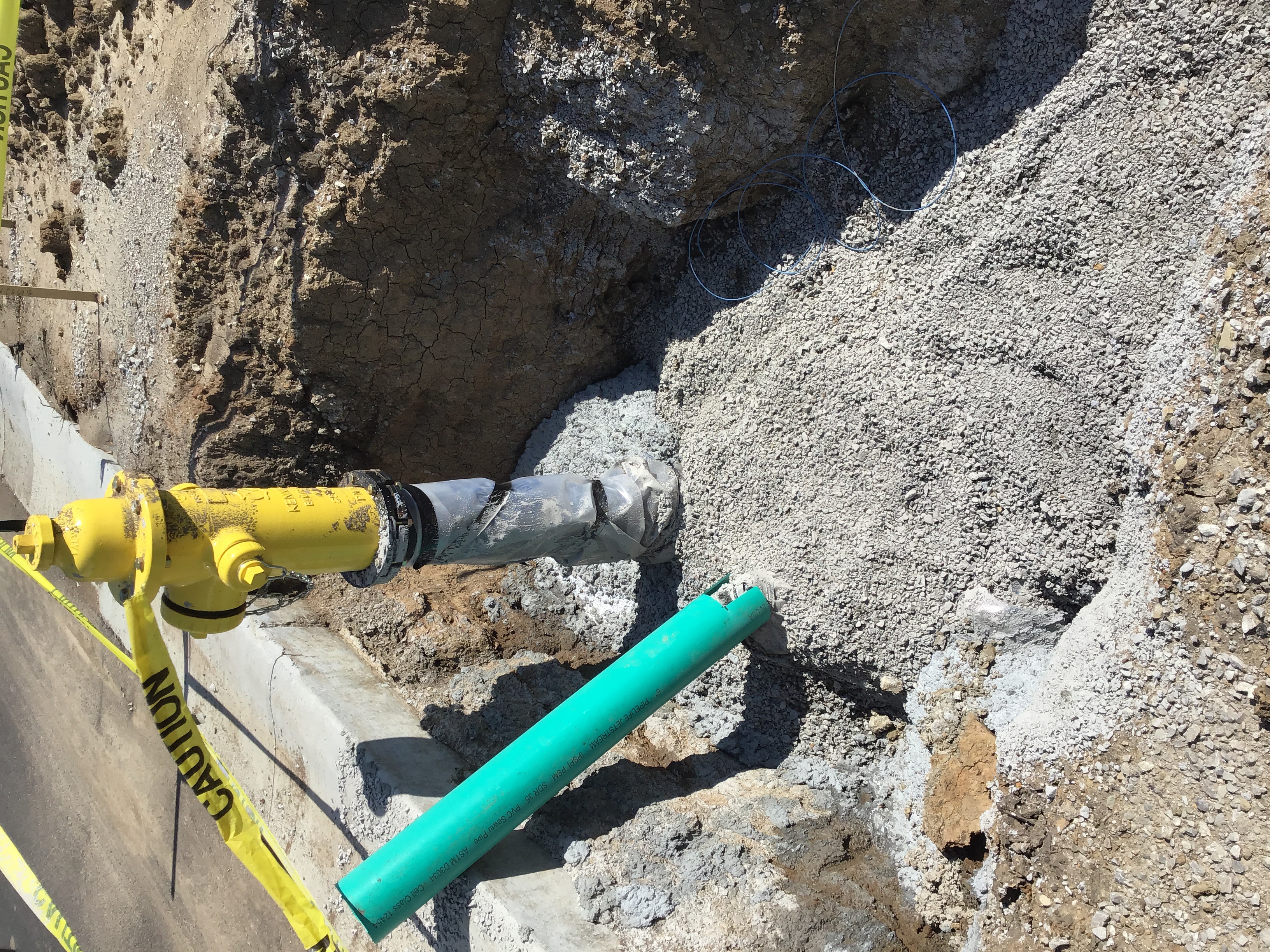

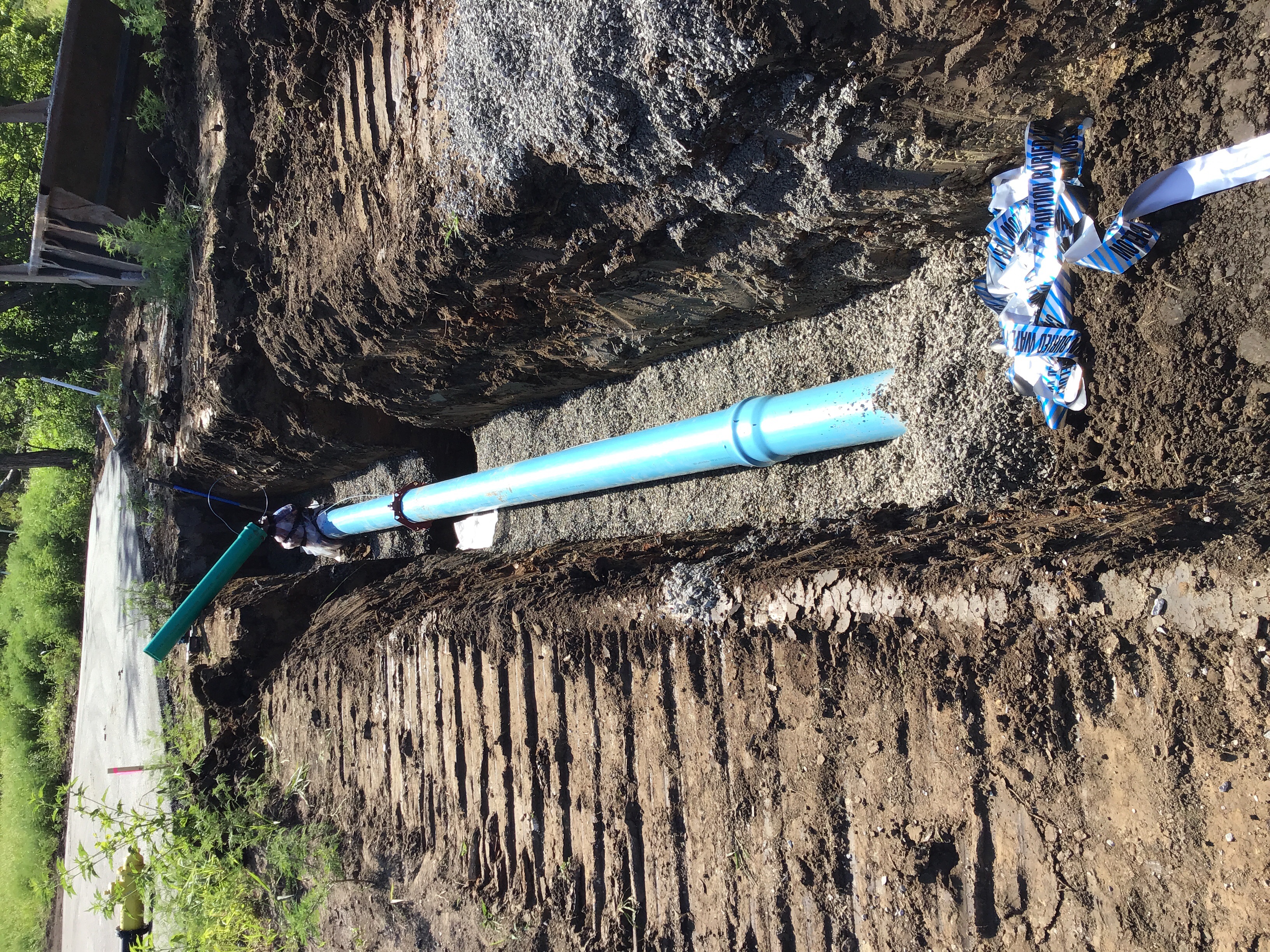

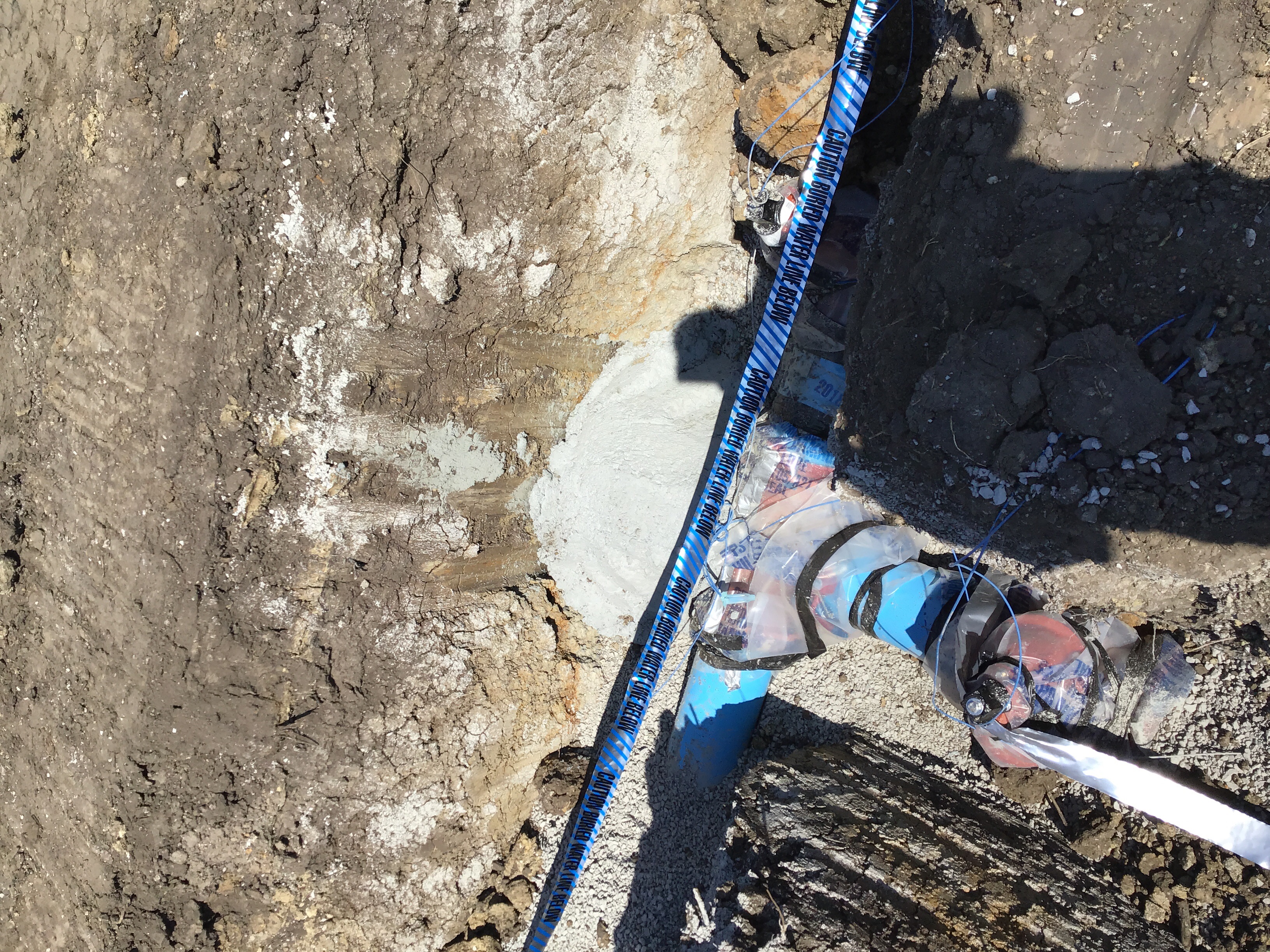

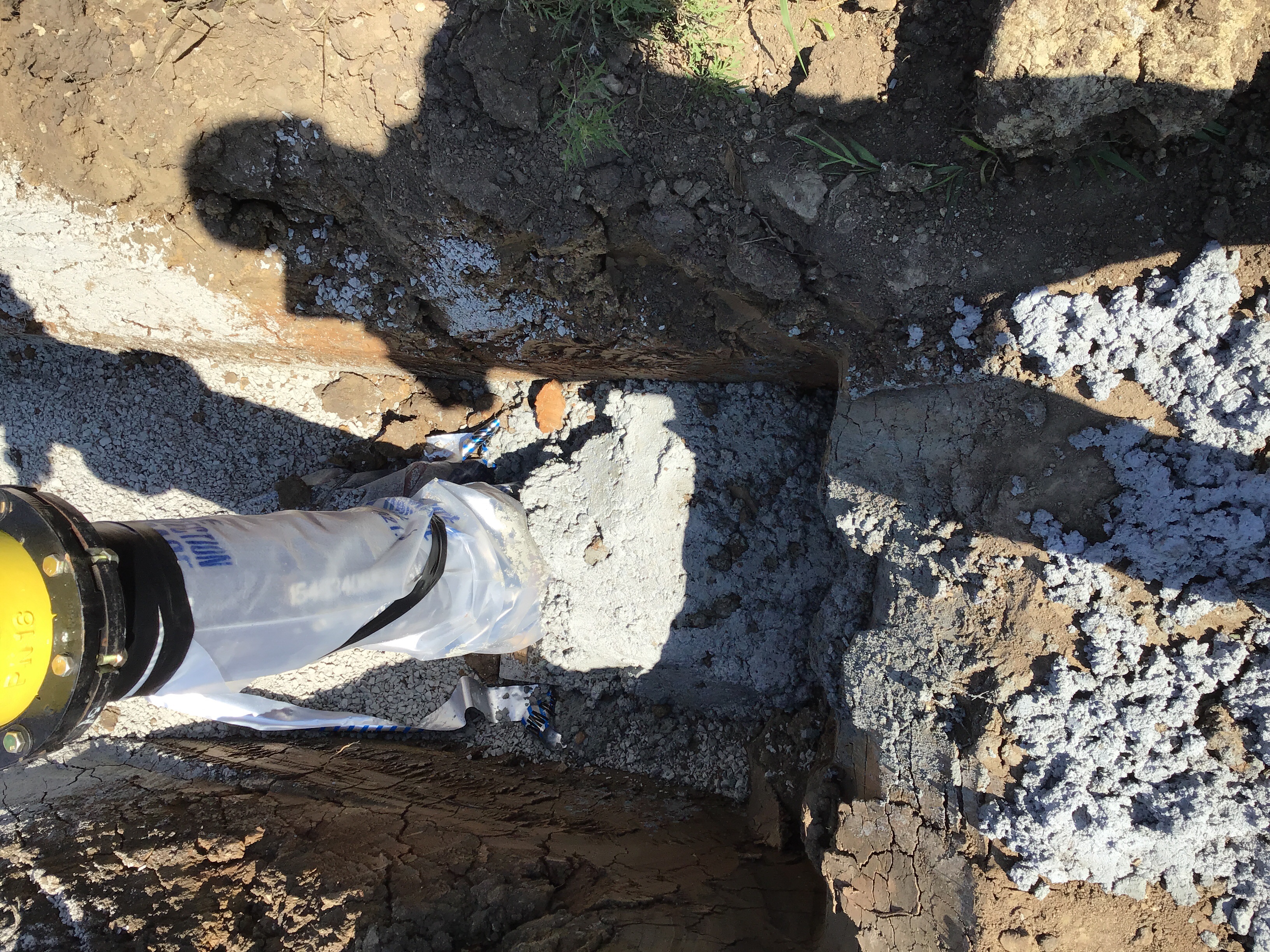

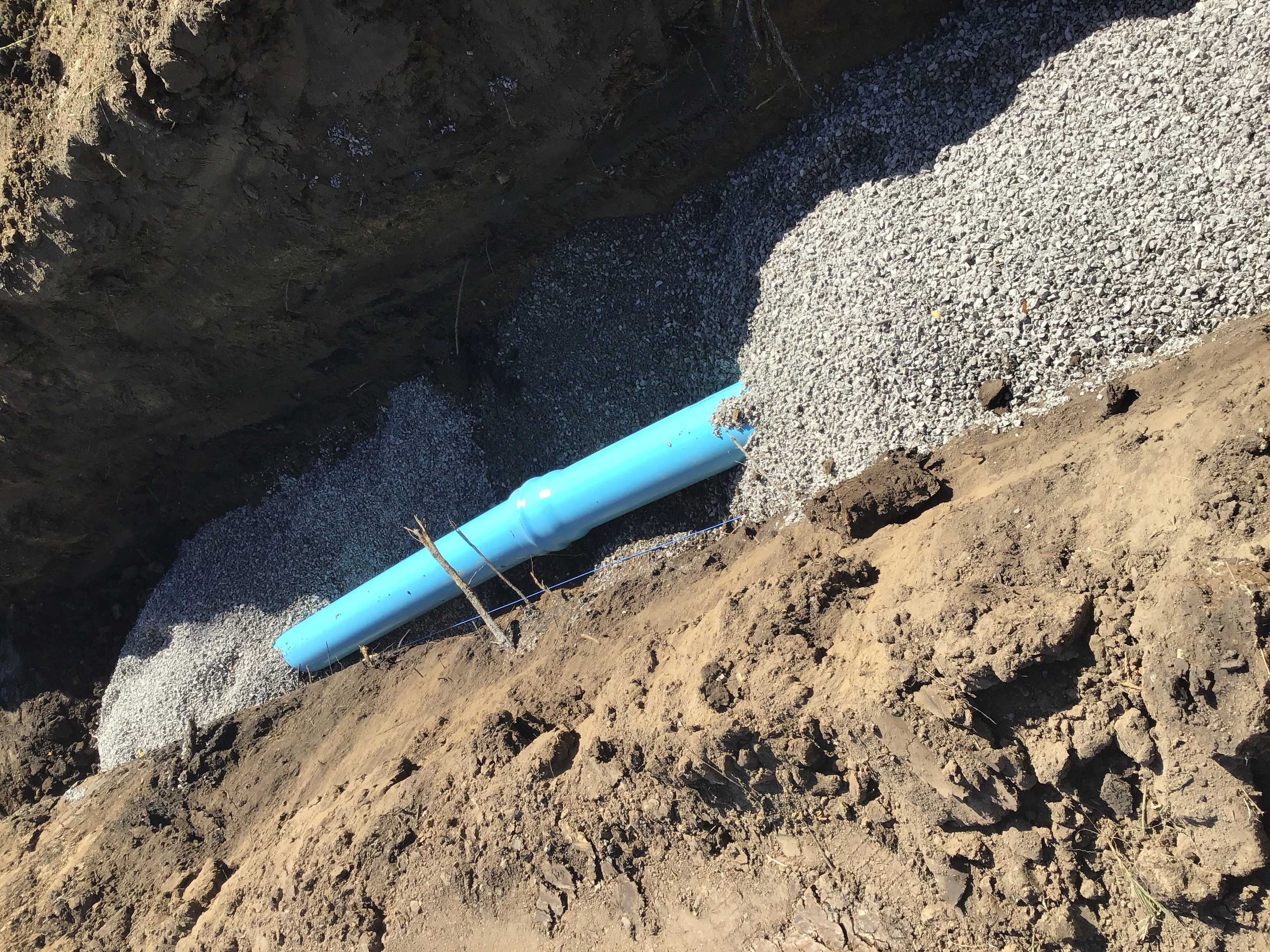

07/19/2019 Water main
07/19/2019 Water main0
07/19/2019 Water main1
07/19/2019 Water main2
07/19/2019 Water main3
07/19/2019 Water main4
07/19/2019 Letter INSPECTION SUMMARY

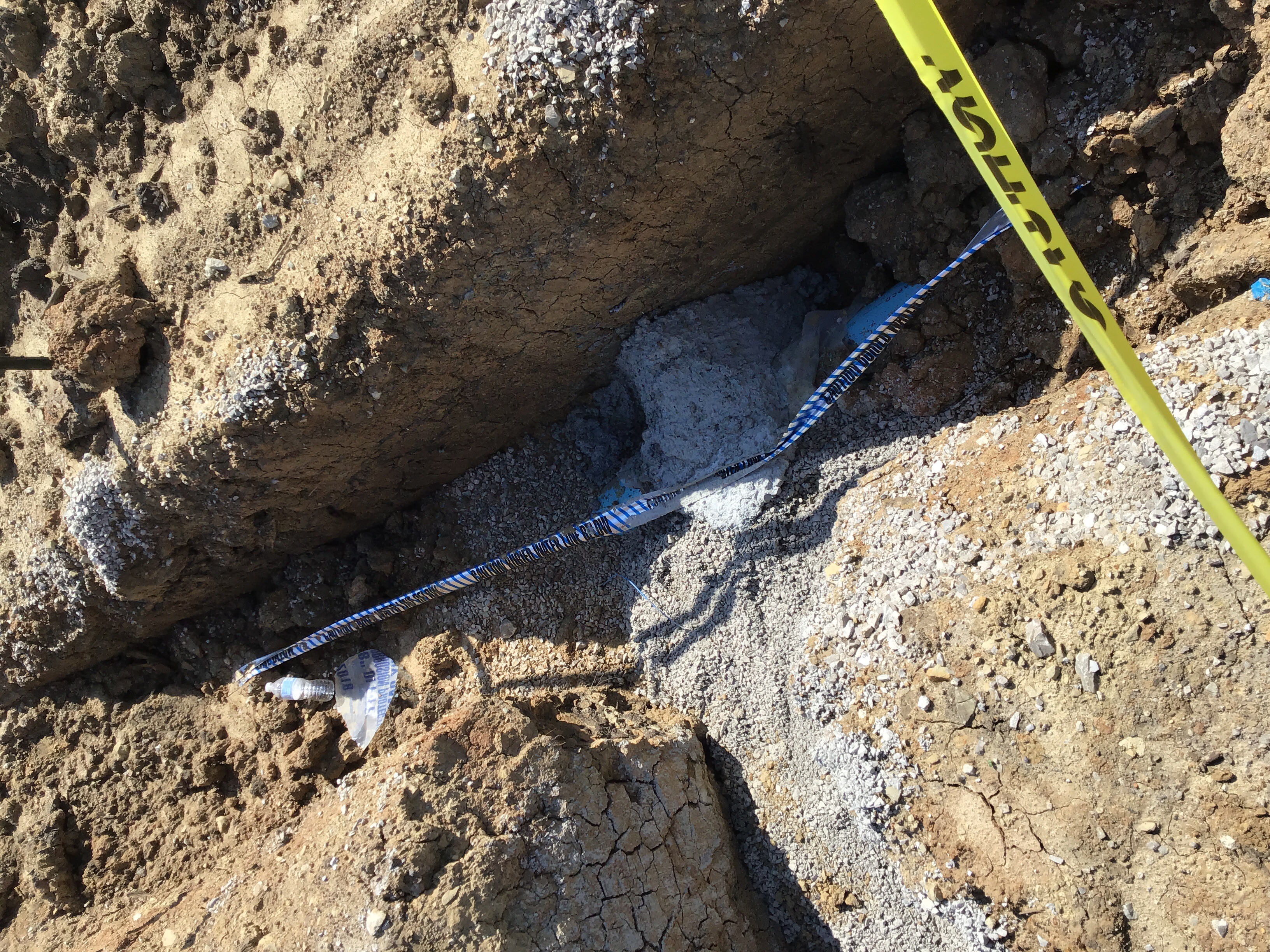

07/19/2019 Concrete Manhole Collar
07/19/2019 Concrete Manhole collar 2
07/19/2019 Letter INSPECTION SUMMARY

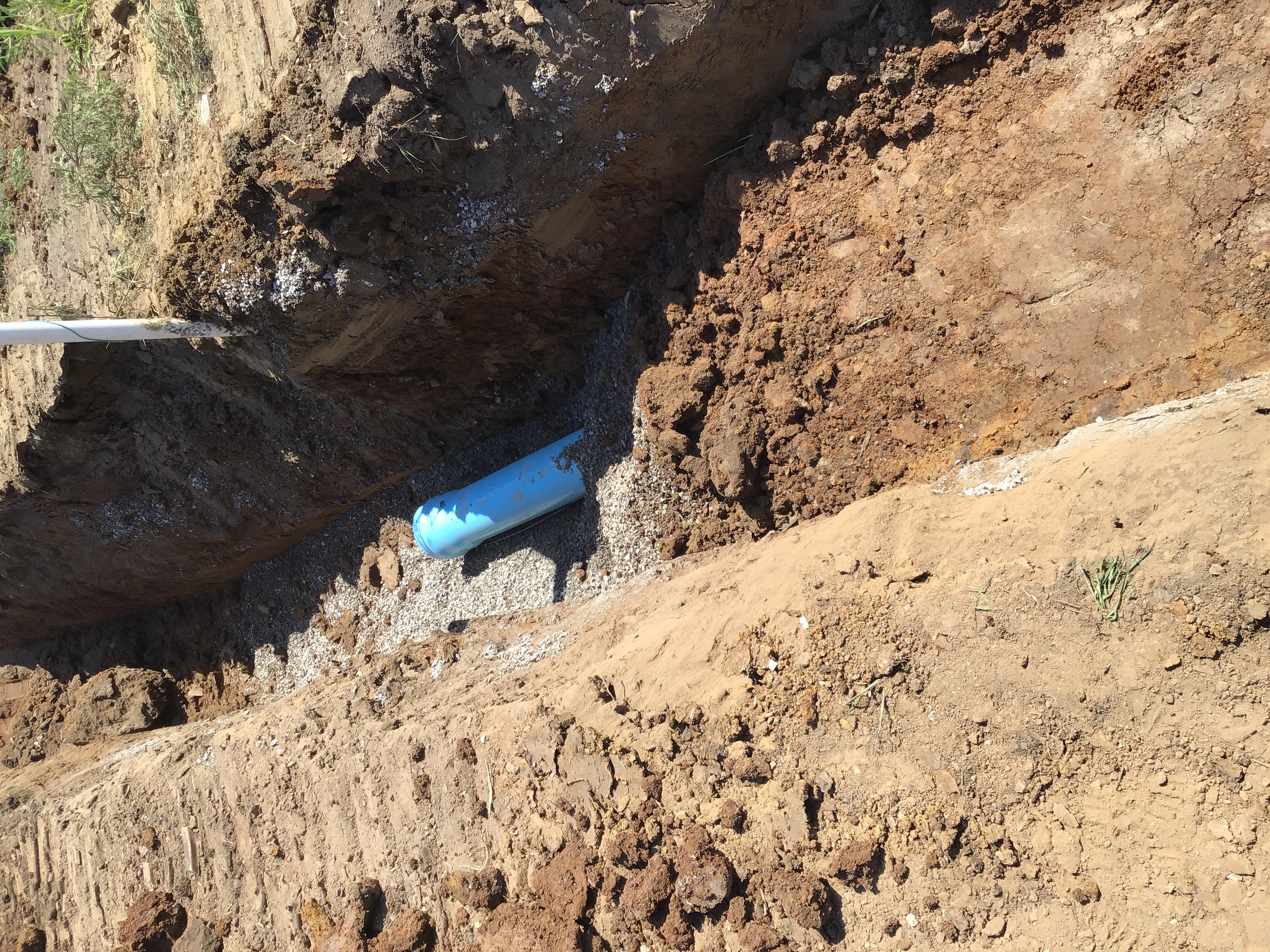

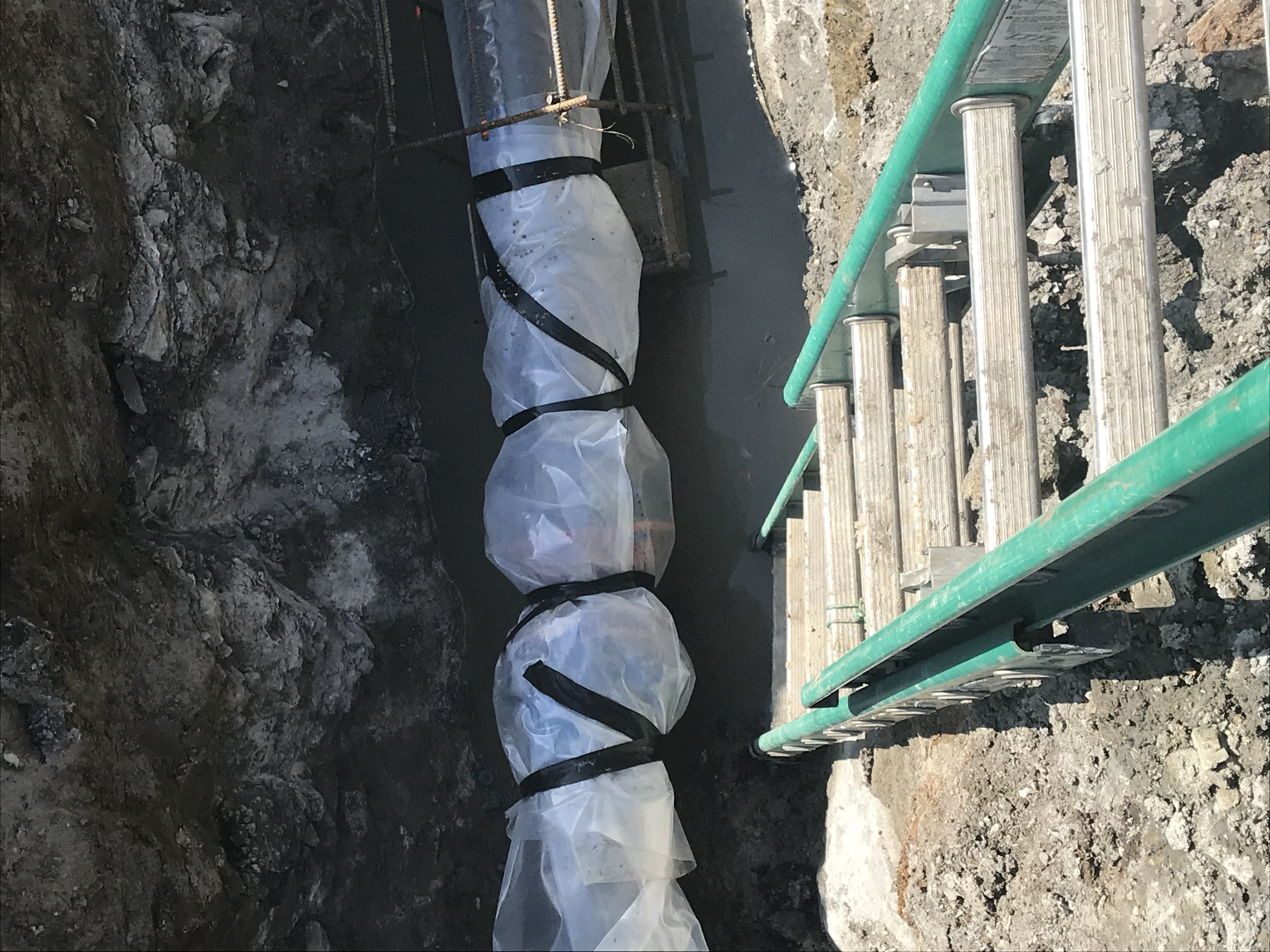

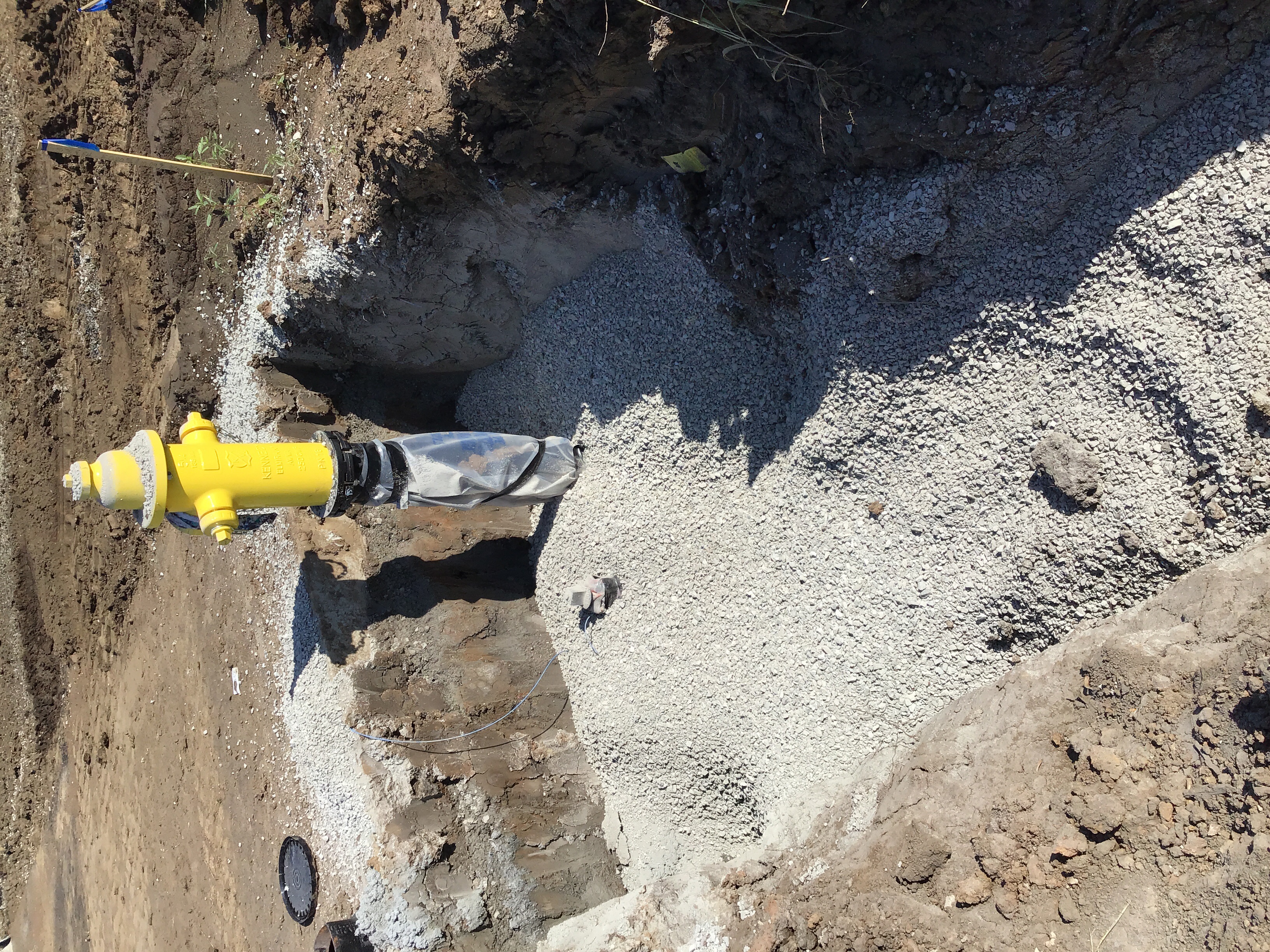

07/23/2019 Water line
07/23/2019 Water line0
07/23/2019 Water line1
07/23/2019 Water line2
07/23/2019 Water line3
07/23/2019 Water line4
07/23/2019 Letter INSPECTION SUMMARY
07/24/2019 image8

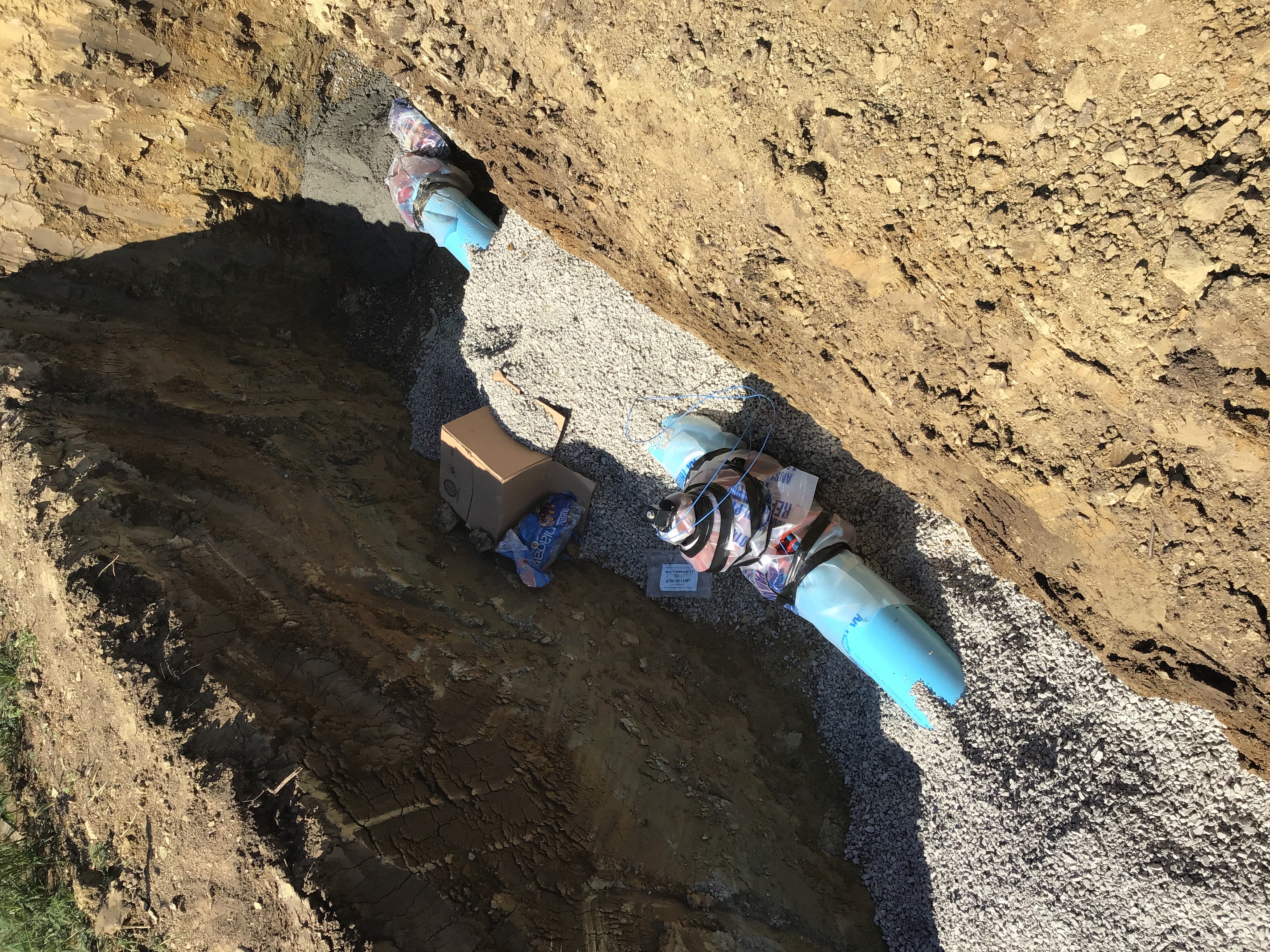

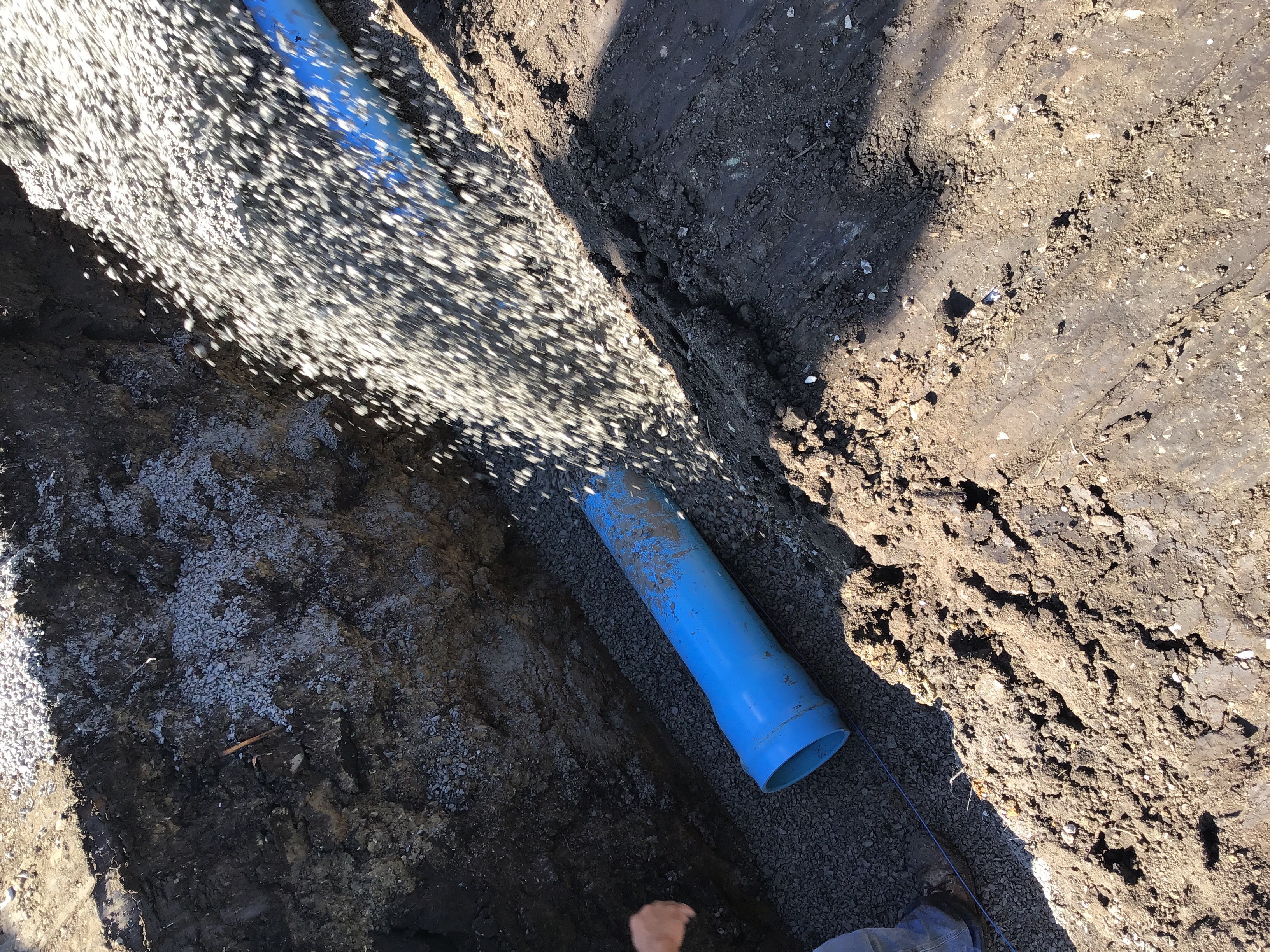

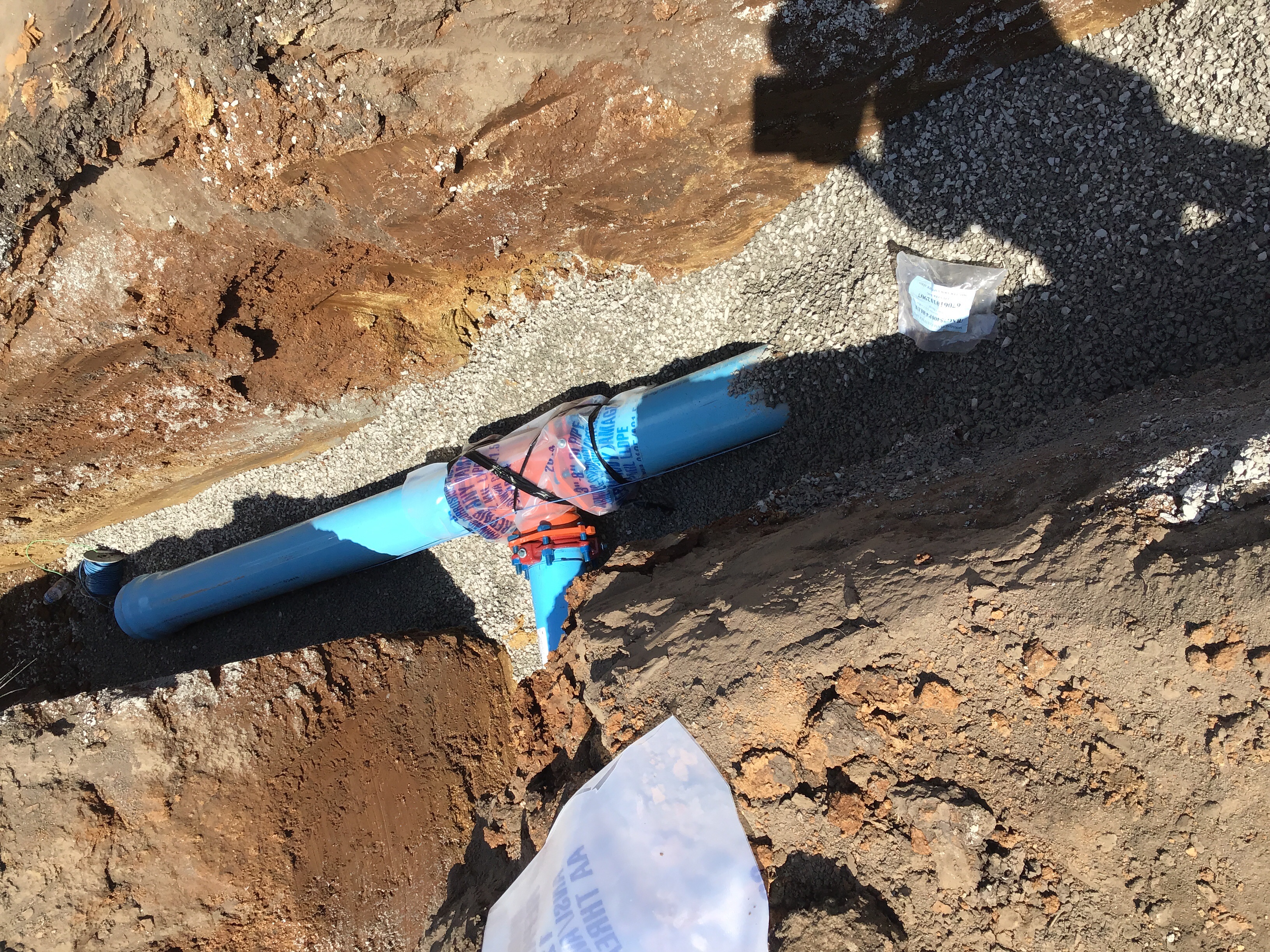

07/24/2019 Water line A
07/24/2019 Water line A0
07/24/2019 Water line A1
07/24/2019 Letter INSPECTION SUMMARY
07/24/2019 Water line A2
07/24/2019 Water line A3
07/24/2019 Water Line A4
07/24/2019 Letter INSPECTION SUMMARY
07/26/2019 image9
07/26/2019 image10

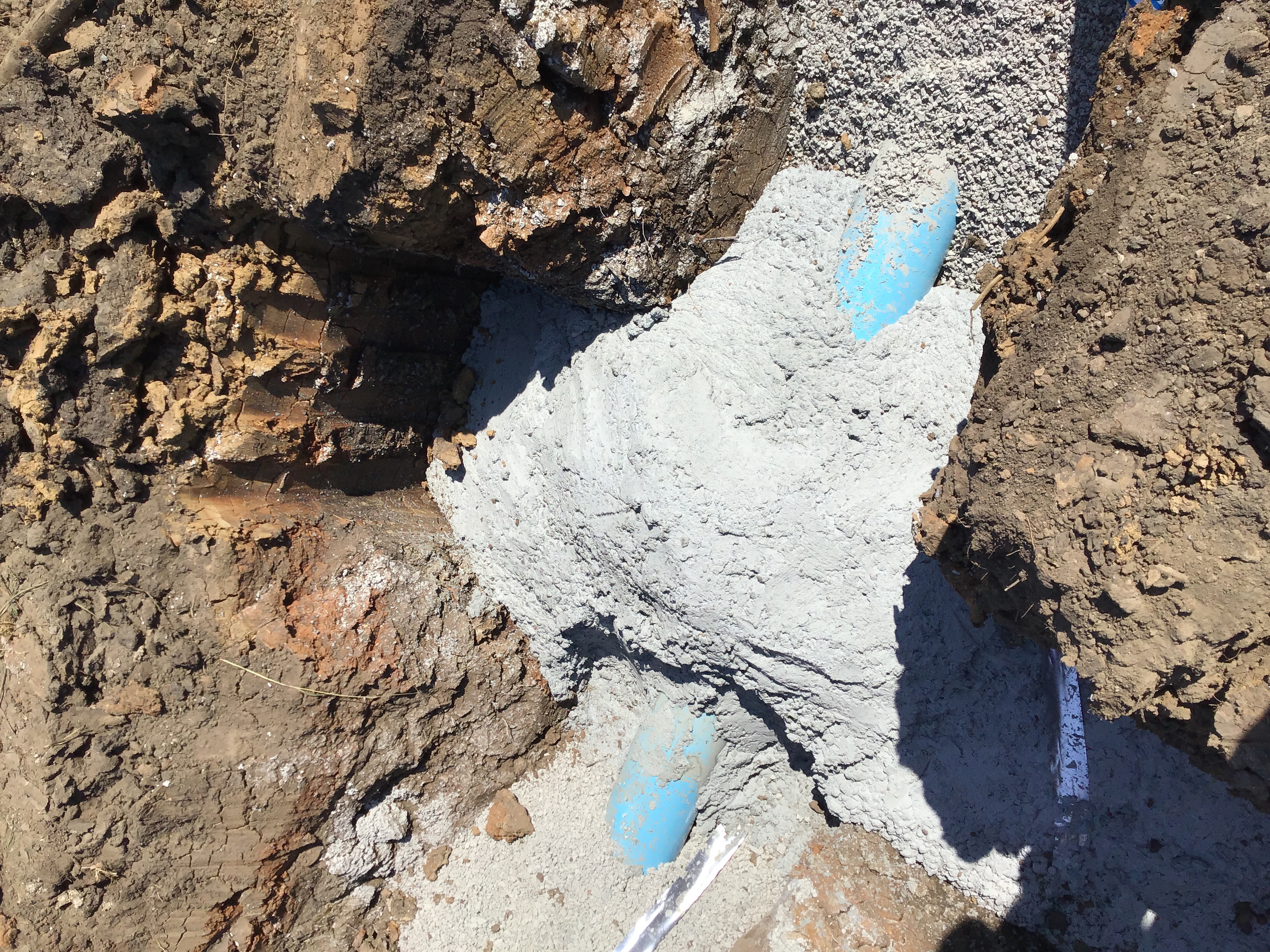

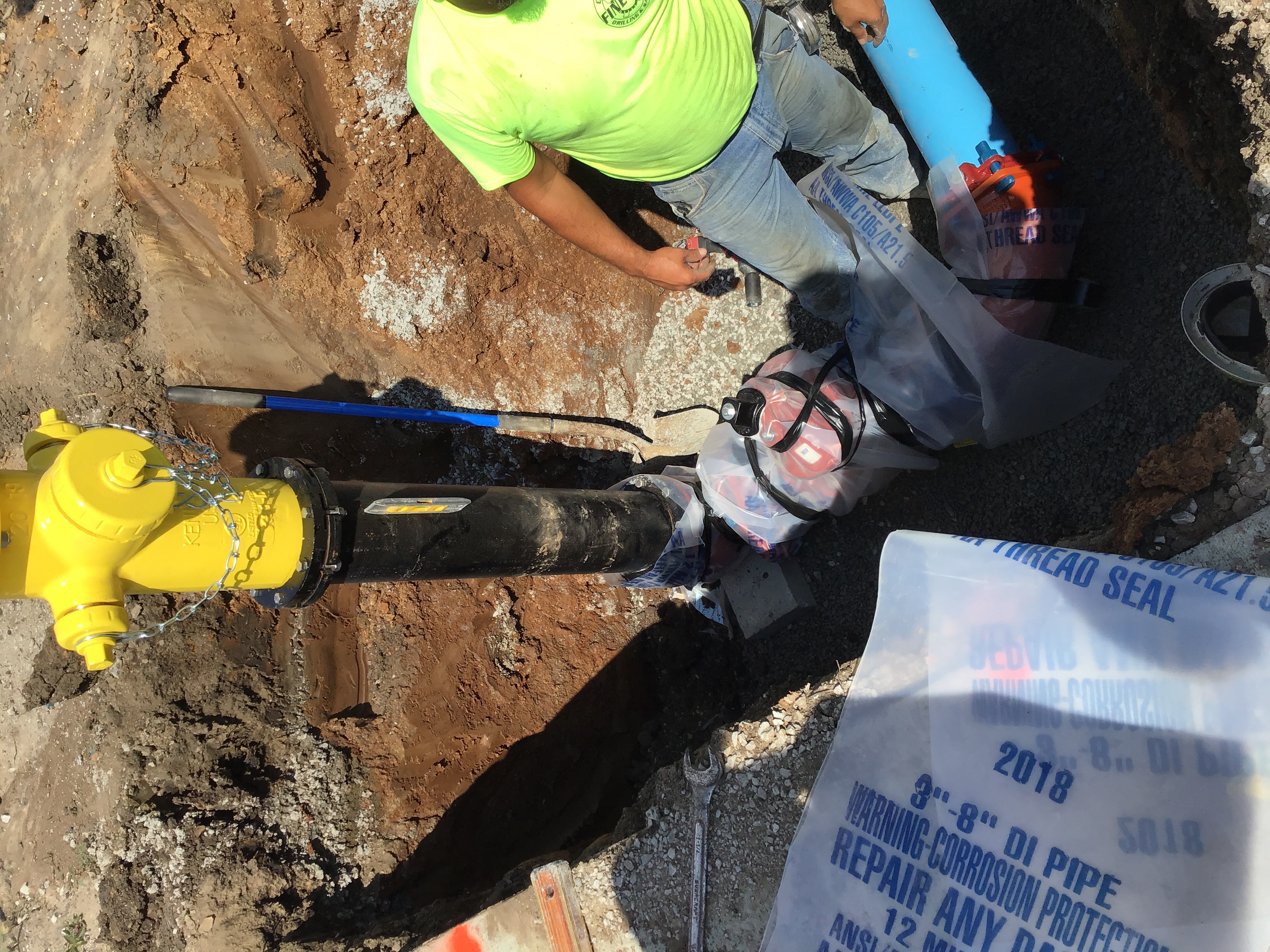

07/26/2019 Water Line C
07/26/2019 Water thrust restraint line C

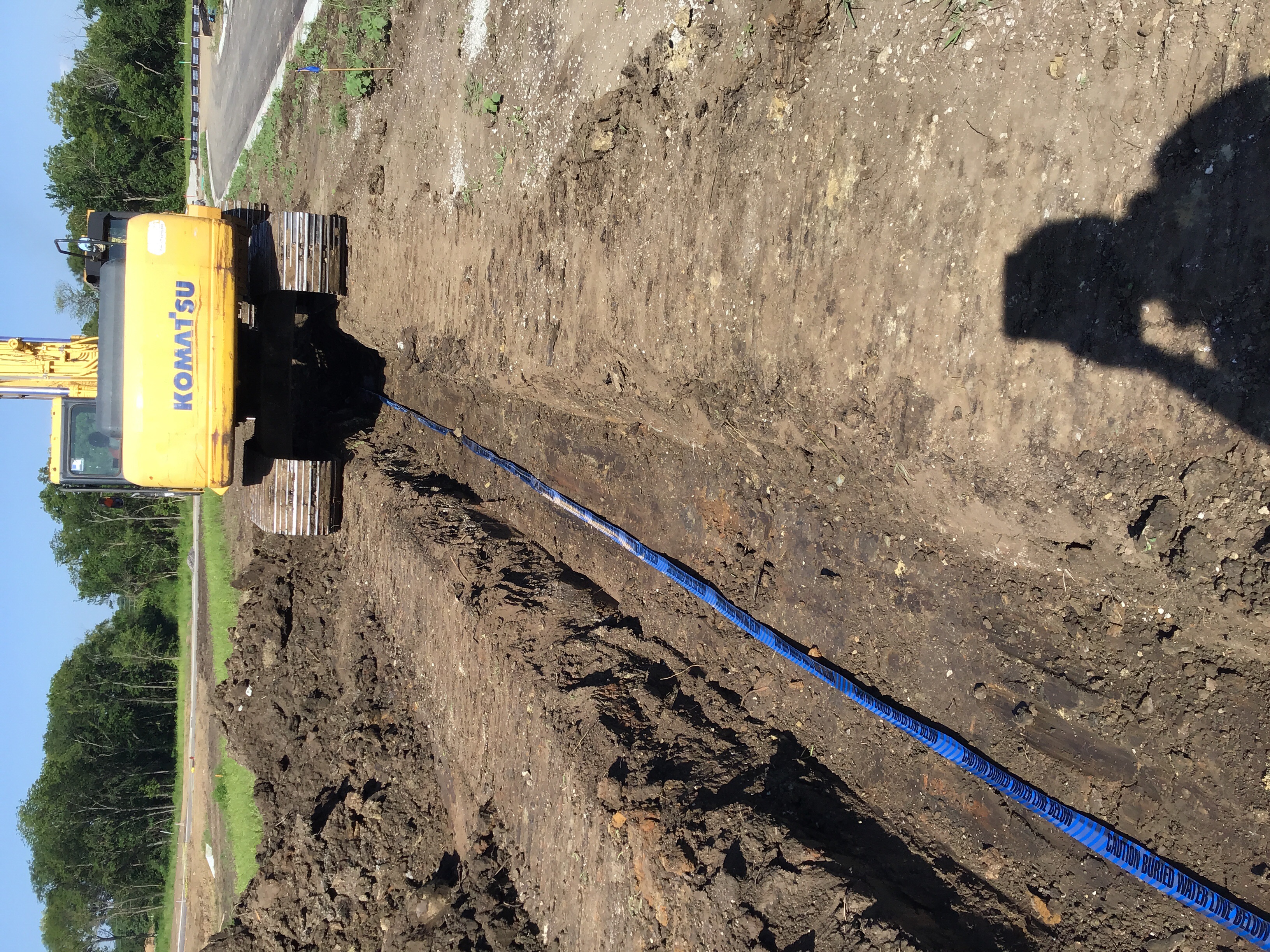

07/26/2019 Water line A kicker
07/26/2019 Water line A
07/26/2019 Water line A5
07/26/2019 Letter INSPECTION SUMMARY
07/30/2019 Water line A6
07/30/2019 Water line A7
08/20/2019 Pryor Rd. West Lane Subgrade

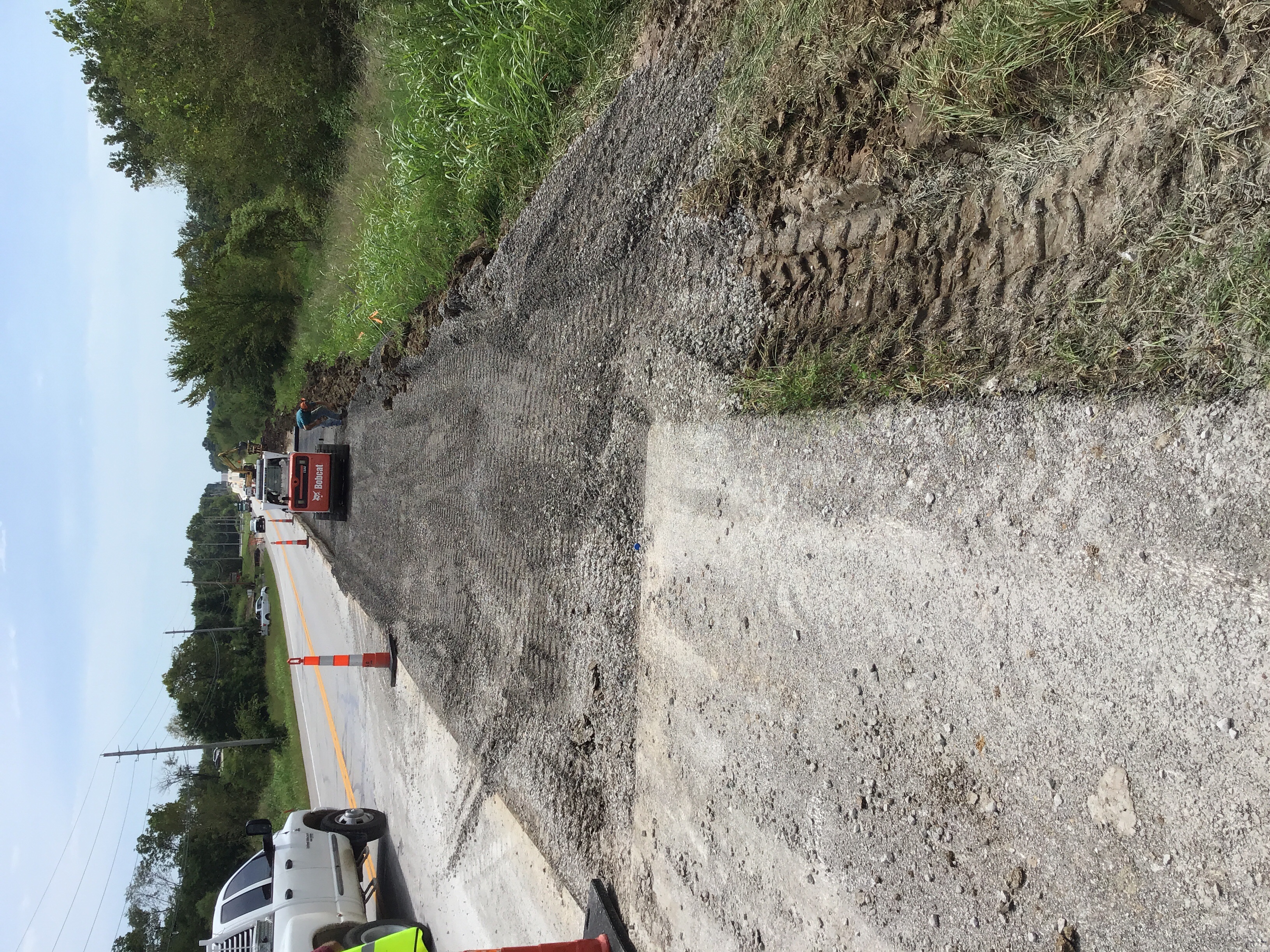

08/20/2019 Pryor Rd west lane subgrade
08/20/2019 Pryor rd west lane subgrade
08/20/2019 Geo grid Pryor rd
08/20/2019 Letter INSPECTION SUMMARY
08/27/2019 Failed ECS devices
08/27/2019 Failed ESC devices
08/27/2019 Letter INSPECTION SUMMARY
08/27/2019 Letter INSPECTION SUMMARY
09/04/2019 Letter INSPECTION SUMMARY
09/05/2019 Letter INSPECTION SUMMARY
09/05/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter INSPECTION SUMMARY
09/06/2019 Pryor rd west lane
09/06/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter INSPECTION SUMMARY
09/06/2019 Letter INSPECTION SUMMARY
09/09/2019 Letter INSPECTION SUMMARY
09/09/2019 Letter INSPECTION SUMMARY
09/11/2019 A3CA19BB-A319-480D-97F5-2542C70A12B4
09/11/2019 5FB40845-FF58-44FD-832F-2EB60091BABD
09/11/2019 358E4EE6-0048-4221-8DC0-AABA0124AEF4
09/11/2019 ABE62DC5-027E-4EEA-B7A5-1C23FC023643
09/11/2019 Letter INSPECTION SUMMARY
09/13/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter INSPECTION SUMMARY
09/17/2019 Letter DE-Daily Inspection Summary
09/18/2019 Letter INSPECTION SUMMARY
09/18/2019 Letter INSPECTION SUMMARY
09/18/2019 Letter INSPECTION SUMMARY
11/05/2019 Letter Stop Work Order
11/07/2019 Letter DE-Daily Inspection Summary
11/07/2019 Letter DE-Daily Inspection Summary

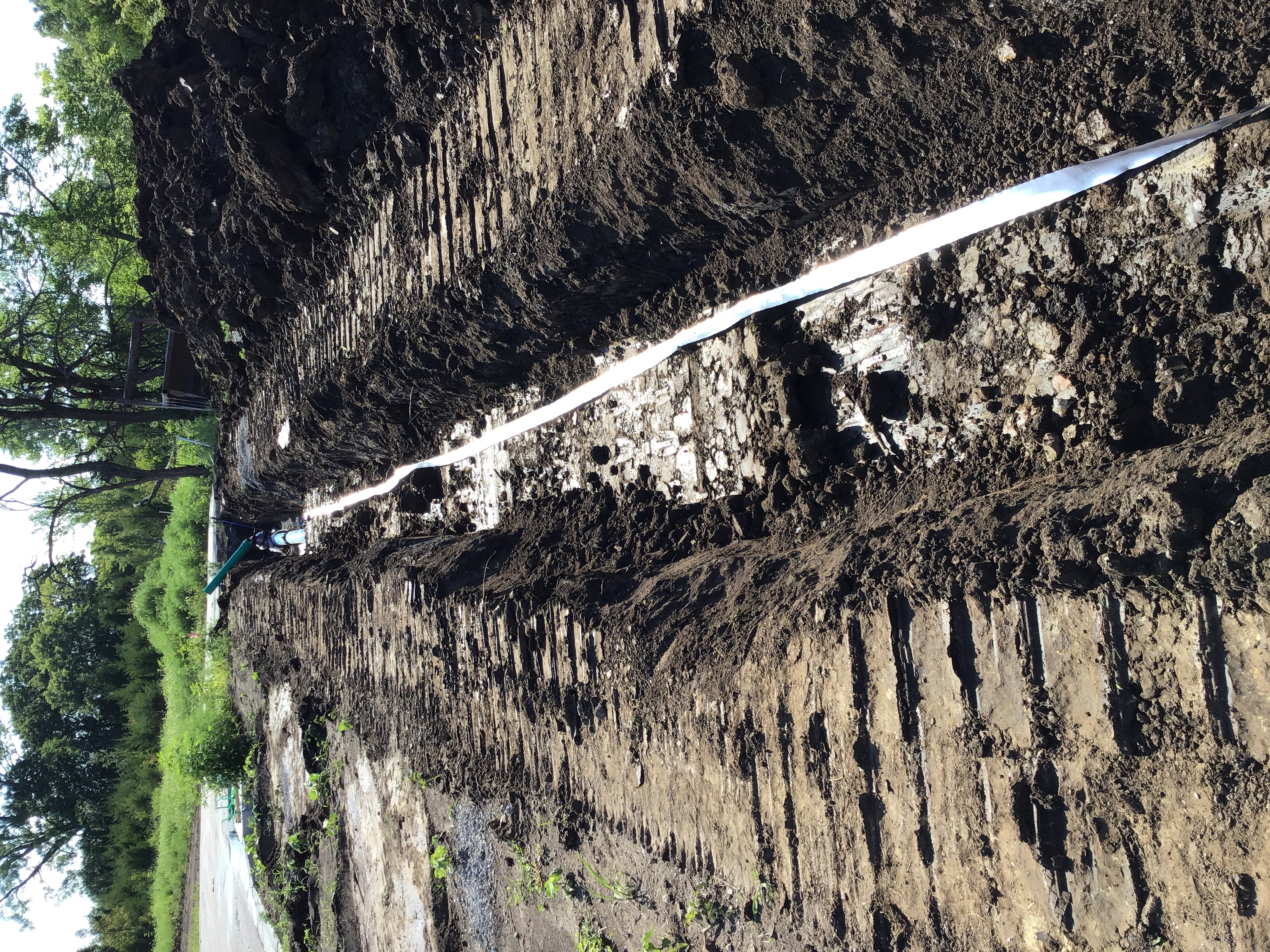

11/12/2019 Water main tie in Pryor Rd
11/12/2019 Letter INSPECTION SUMMARY
11/12/2019 Letter INSPECTION SUMMARY
11/18/2019 Letter INSPECTION SUMMARY
11/18/2019 Letter INSPECTION SUMMARY
11/18/2019 Letter INSPECTION SUMMARY
11/18/2019 Plans Sanitary asbuilt
11/21/2019 Letter DE-Daily Inspection Summary
11/21/2019 Plans Whispering Woods Master Drainage Plan AB
11/21/2019 WO#1K91309 - City of Lees Summit
11/24/2019 Letter DE-Daily Inspection Summary
11/25/2019 Letter DE-Daily Inspection Summary
11/26/2019 Letter INSPECTION SUMMARY
11/26/2019 Letter INSPECTION SUMMARY
11/26/2019 Letter INSPECTION SUMMARY
11/26/2019 Letter INSPECTION SUMMARY
12/05/2019 Letter DE-Punch List
12/06/2019 Plans MDP WITH REVISED MBOE 12-2-9
12/05/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
12/06/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
12/06/2019 Letter DE-Punch List
12/09/2019 Whispering Woods 1st Plat Signed Certificate of Substantial Completion
12/09/2019 Whispering Woods 1st Plat Signed Punch List
12/10/2019 Letter Whispering Woods Outstanding Construcion estimate 12-9-19
12/16/2019 Letter DE-Certificate of Substantial Completion Multiple Lot
12/17/2019 Whispering Woods 1st Plat Signed Full Certificate of Substantial Completion
12/30/2019 Letter INSPECTION SUMMARY
01/02/2020 Letter INSPECTION SUMMARY
01/02/2020 Letter INSPECTION SUMMARY
03/09/2020 Letter INSPECTION SUMMARY
03/27/2020 Letter INSPECTION SUMMARY
04/02/2020 Letter INSPECTION SUMMARY
05/19/2020 Letter INSPECTION SUMMARY
05/26/2020 Letter INSPECTION SUMMARY
02/22/2021 Security Document Strom, sanitary and water maintenance bond
02/19/2021 Activity Document Whispering Woods 1st Final Affidavit
06/17/2021 Letter DE-Daily Inspection Summary
06/18/2021 Letter Inspection Summary
08/04/2023 Letter DE-Certificate of Final Acceptance (Commercial)
Upload Documents

Guidelines For Electronically Submitting Documents:

  • Submitted documents should be under 100MB in size.
  • Accepted file extensions:
    • pdf, jpg, xls, doc, xlsx, docx, dwg
  • All plans shall be to scale.
  • Recommended naming conventions:
    • Keep filename consistent.
    • Avoid the use of non-friendly filenames. (ex. k9dk38fj3.pdf)
    • Avoid inappropriate language in filenames.
  • Submitted documents will be stamped at the conclusion of the review.
    • The stamp will be placed in the upper right hand corner of the document. It is recommeded that this area, to the extent possible, be left blank so that no information is lost when the the stamp is applied.
Remember to click the Upload Document button. If you are applying for a New permit, make sure to click the "next step" button after you have completed the upload of documents

Select any documents you wish to provide:

Portal Home
